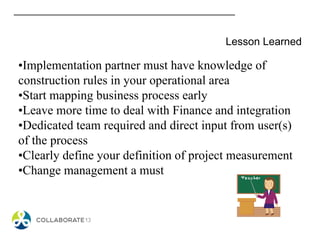

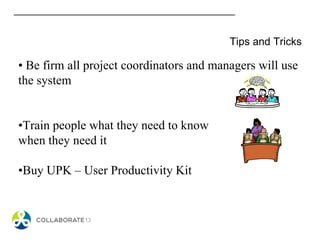

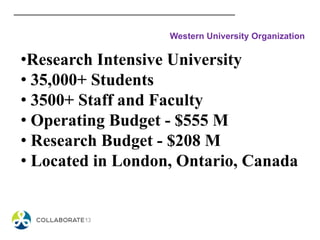

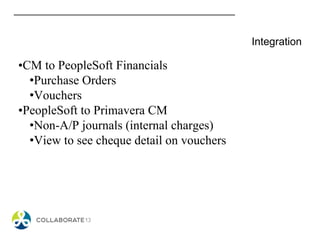

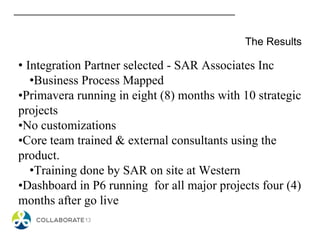

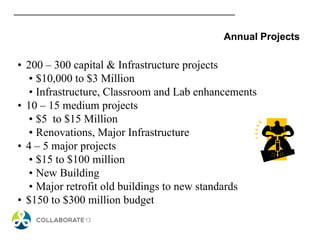

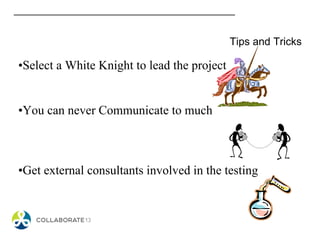

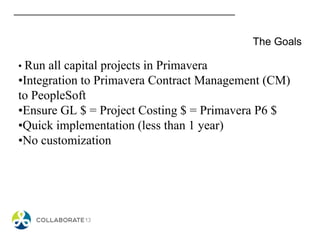

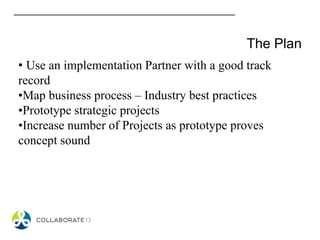

This presentation summarizes Western University's implementation of Primavera P6 and its integration with PeopleSoft. It discusses Western's goals to run all capital projects in Primavera P6 and integrate it with PeopleSoft's financial system. The presentation outlines Western's plan, which included using an implementation partner and mapping business processes. It provides results, noting the system went live in eight months for 10 strategic projects with no customization. Lessons learned included starting process mapping early and allowing time for finance integration. Tips included selecting a project leader, effective communication, and training users as needed.
