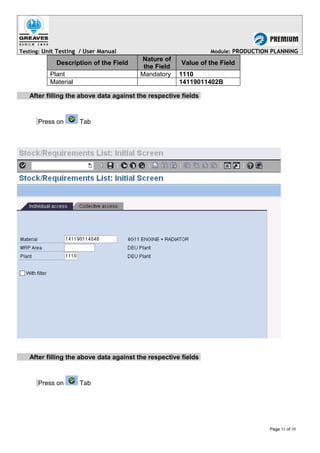

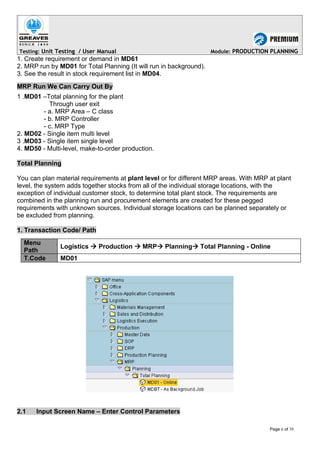

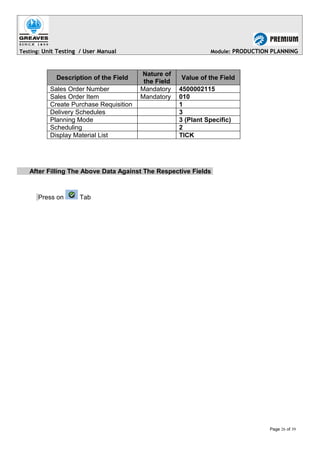

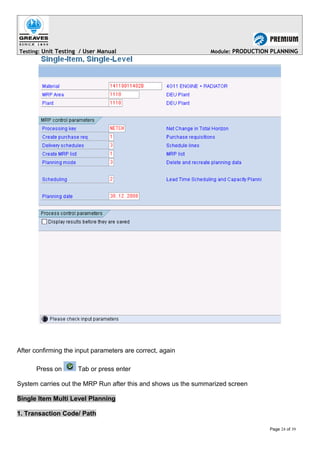

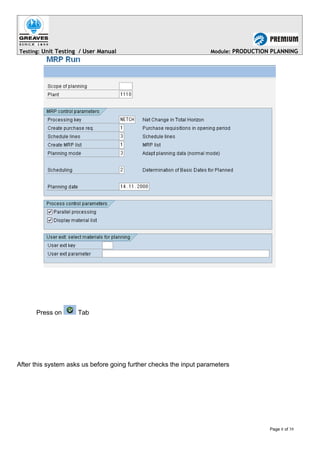

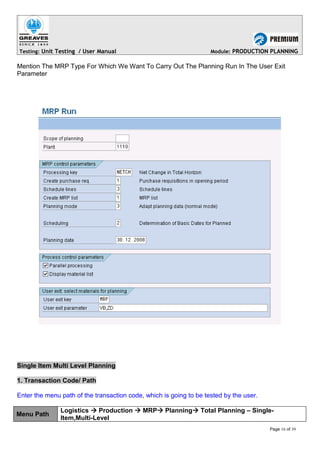

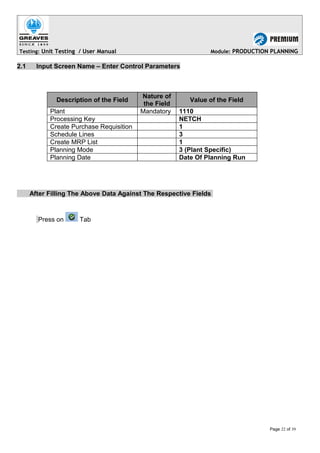

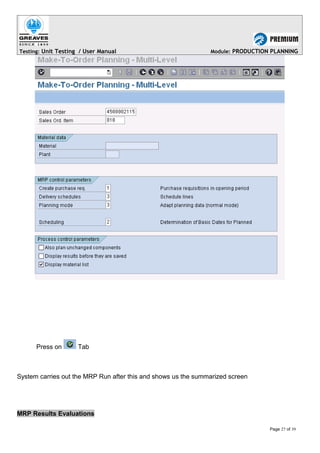

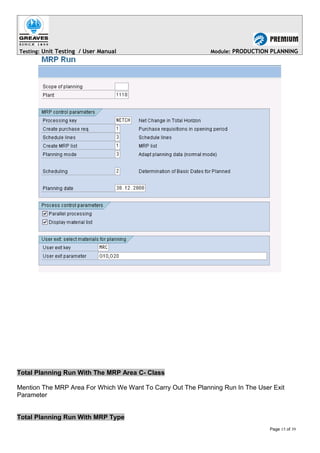

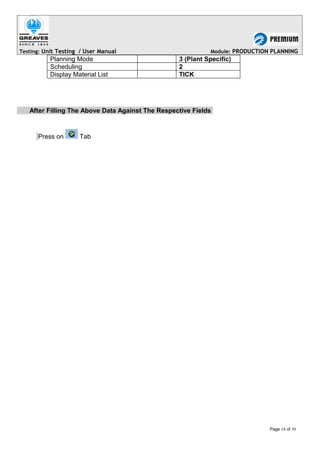

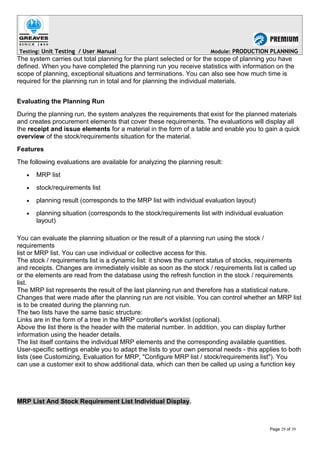

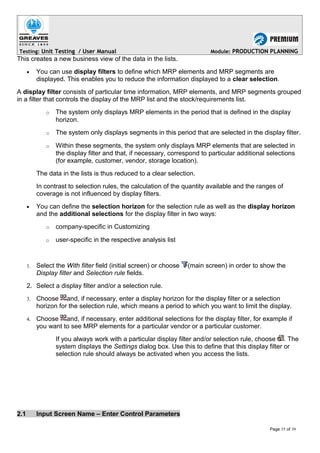

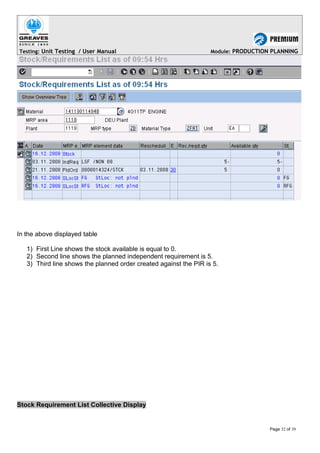

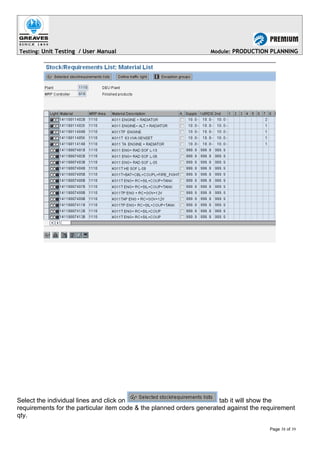

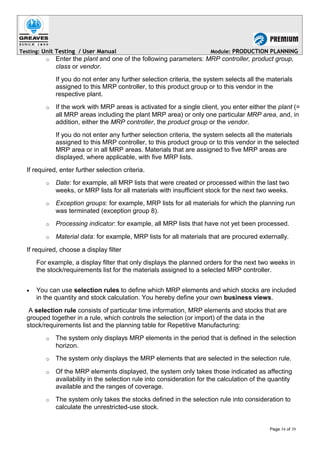

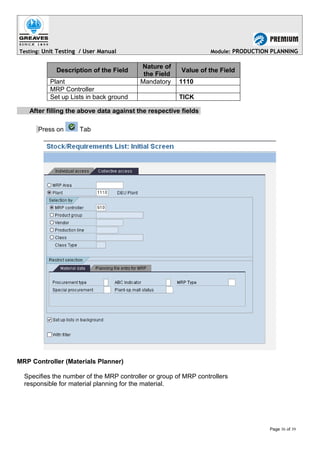

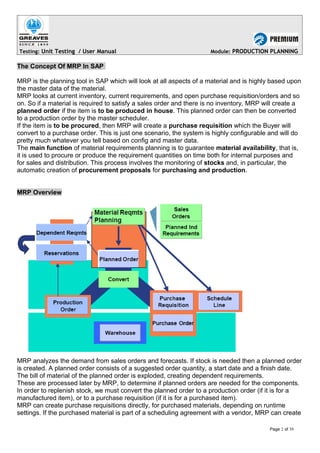

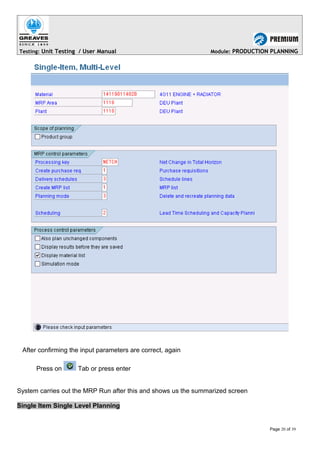

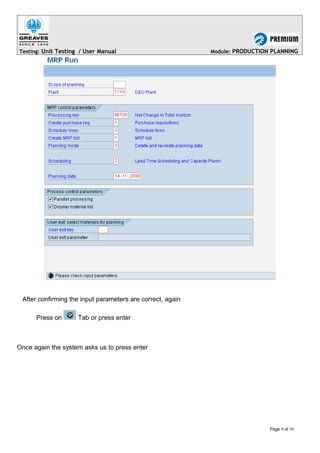

The document provides information on material requirements planning (MRP) in SAP, including:
1) MRP analyzes demand and available stock to determine if planned orders are needed for materials. It will create planned production or purchase orders if inventory is insufficient.
2) The MRP run procedure involves exploding bills of materials to create dependent requirements and planned orders to fulfill requirements.
3) Control parameters for total MRP planning runs include planning mode, creation of purchase requisitions/schedules, and planning by plant, MRP area, or MRP type.
