GEORGETOWN ISD
2010 BOND PROGRAM UPDATE

     D E C E MB E R 2 011
                            Huckabee
2010 BOND PROGRAM UPDATE

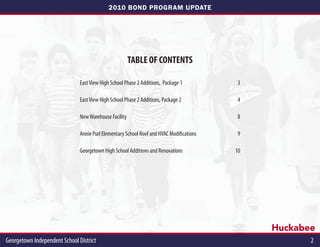

                                                        TABLE OF CONTENTS

                               East View High School Phase 2 Additions, Package 1          3

                               East View High School Phase 2 Additions, Package 2          4

                               New Warehouse Facility                                      8

                               Annie Purl Elementary School Roof and HVAC Modifications    9

                               Georgetown High School Additions and Renovations           10

                                                                                               Huckabee
Georgetown Independent School District                                                                2
2010 BOND PROGRAM UPDATE                                                     General Contractor

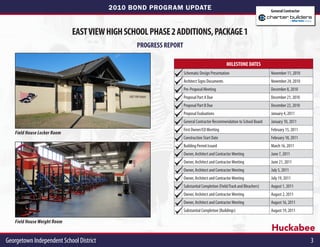

                             EAST VIEW HIGH SCHOOL PHASE 2 ADDITIONS, PACKAGE 1
                                               PROGRESS REPORT

                                                                                             MILESTONE DATES
                                                                 Schematic Design Presentation                        November 11, 2010
                                                                 Architect Signs Documents                            November 24, 2010
                                                                 Pre-Proposal Meeting                                 December 8, 2010
                                                                 Proposal Part A Due                                  December 21, 2010
                                                                 Proposal Part B Due                                  December 22, 2010
                                                                 Proposal Evaluations                                 January 4, 2011
                                                                 General Contractor Recommendation to School Board    January 10, 2011
                                                                 First Owner/CO Meeting                               February 15, 2011
   Field House Locker Room
                                                                 Construction Start Date                              February 18, 2011
                                                                 Building Permit Issued                               March 16, 2011
                                                                 Owner, Architect and Contractor Meeting              June 7, 2011
                                                                 Owner, Architect and Contractor Meeting              June 21, 2011
                                                                 Owner, Architect and Contractor Meeting              July 5, 2011
                                                                 Owner, Architect and Contractor Meeting              July 19, 2011
                                                                 Substantial Completion (Field/Track and Bleachers)   August 1, 2011
                                                                 Owner, Architect and Contractor Meeting              August 2, 2011
                                                                 Owner, Architect and Contractor Meeting              August 16, 2011
                                                                 Substantial Completion (Buildings)                   August 19, 2011

   Field House Weight Room
                                                                                                                      Huckabee
Georgetown Independent School District                                                                                                     3
2010 BOND PROGRAM UPDATE                                                                                                                General Contractor

                                                     EAST VIEW HIGH SCHOOL PHASE 2 ADDITIONS, PACKAGE 2

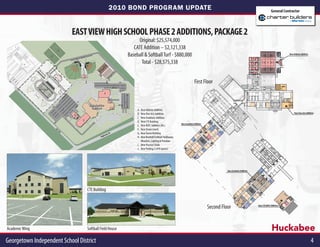

                                                                                                                               Original: $25,574,000
                                         I
                                                                                                                            CATE Addition – $2,121,338
                                I
                                                             J
                                                                                                                         Baseball & Softball Turf - $880,000                                                                                           New Athletic Addition

                                                         H
                                                                     H                                                          Total - $28,575,338
                                                                                           F

                                                                                       G                 J
                                                                 H

                                                                                                                 J
                                                                                                                                                                                  First Floor
                Bid Package 1
                                                                                               A

                                                                                                    B                J
                                                                          Existing East View
                                                 J                           High School                     B
                                                                                                                              A. New Athletic Addition
                                                                                                                              B. New Fine Arts Addition                                                                                                     New Fine Arts Addition
                                                     D
                                                         E                                                                    C. New Academic Addition
                                                                 C
                                                                                                                              D. New CTE Building
                                                                                                                                                                     New Academic Addition
                                                                                                                              E. New ROTC Addition (Alt.)
                                    CR
                                         10                                                                                   F. New Tennis Courts
                                             4
                                                                                                 ay
                                                                                                    29                        G. New Tennis Building
                                                                                               hw
                                                                                        Hig                                   H. New Baseball/Softball Fieldhouse,
                                                                                                                                 Bleachers, Lighting & Pressbox
                                                                                                                              I. New Practice Fields
                                                                                                                              J. New Parking (1,070 spaces)

                                                                                                                                                                                                       New Academic Addition

                                                                         CTE Building

                                                                                                                                                                                             Second Floor                      New CTE/ROTC Addition

Academic Wing                                                            Softball Field House                                                                                                                                                Huckabee
Georgetown Independent School District                                                                                                                                                                                                                                         4
2010 BOND PROGRAM UPDATE

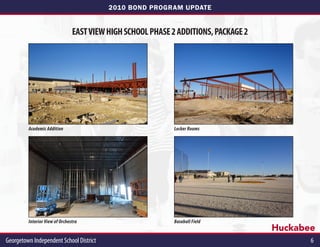

                                                EAST VIEW HIGH SCHOOL PHASE 2 ADDITIONS, PACKAGE 2
                                                                                                PROGRESS REPORT
  ACADEMIC ADDITION                                                                                                                              MILESTONE DATES
  •	  Steel structure is making progress.
  •	  Overhead utility lines and CMU walls have begun.                                                         Schematic Design Presentation                                    January 1, 2011
  •	  	2nd	floor	slab	will	begin	the	end	of	this	week.
                                                                                                               Architect Signs Documents                                        March 8, 2011
  CATE/ROTC                                                                                                    Building Permit Application Submittal                            March 15, 2011
  •	  Underground plumbing and electrical utilities are making progress.
  •	  Slab work will resume in January.                                                                        Site Plan Application Submittal                                  March 17, 2011
  •	  After	slab	work	is	complete	and	metal	building	has	arrived,	steel	structure	will	begin.
                                                                                                               Pre-Proposal Meeting                                             March 22, 2011
  ATHLETIC ADDITION                                                                                            Tour with General Contractors at East View Ninth Grade Center    March 30, 2011
  •	  CMU wall along the existing building is complete.
  •	  Steel	structure	has	begun	at	the	locker	room	area.	The	gym	area	will	be	started	after	the	locker	room	   Proposal Part A Due                                              April 7, 2011
      area is complete.
                                                                                                               Proposal Part B Due                                              April 8, 2011
  •	  CMU walls will begin next.
                                                                                                               Proposal Evaluations                                             April 11, 2011
  FINE ARTS ADDITION – DRAMA
  •	   Steel	structure	and	roof	structure	are	complete.	Concrete	slabs	are	complete.                           Received City Building Dept. Plan Review Comments                April 14, 2011
  •	   Overhead utility lines have begun.
                                                                                                               General Contractor Recommendation to School Board                April 18, 2011
  •	   Metal	decking	and	roofing	will	begin	next.
                                                                                                               Received City Planning Dept. Plan Review Comments                April 25, 2011
  FINE ARTS ADDITION – ORCHESTRA
  •	   CMU walls are complete.                                                                                 Construction Start Date                                          May 19, 2011
  •	   Interior	metal	stud	framing	has	begun.
                                                                                                               First Owner/CO Meeting                                           May 24, 2011
  •	   Roofing	has	begun.
                                                                                                               Building Permit Issued                                           June 1, 2011
  BASEBALL,	SOFTBALL,	TENNIS	AND	SITE
  •	  CMU	walls	at	field	house	are	nearly	complete.	Mezzanine	slab	is	in	place.                                Owner, Architect and Contractor Meeting                          November 8, 2011
  •	  CMU	walls	have	been	started	at	each	press	box.	Roofs	for	press	boxes,	dugouts,	and	tennis	building
                                                                                                               Owner, Architect and Contractor Meeting                          November 15, 2011
      will begin this week.
  •	  Fencing	and	netting	is	being	installed	around	the	fields.	Grading	at	both	fields	is	making	progress.     Owner, Architect and Contractor Meeting                          November 22, 2011
  •	   Grandstands	will	arrive	mid-December	and	are	scheduled	to	be	completed	by	the	end	of	December.
  •	   Cutting	and	grading	of	parking	lots	and	drives	continues.	Concrete	walks	will	begin	this	week.          Owner, Architect and Contractor Meeting                          November 29, 2011
  •	   Grading	and	cutting	for	the	tennis	courts	has	been	started.
                                                                                                               Substantial Completion                                           June 27, 2012

                                                                                                                                                                               Huckabee
Georgetown Independent School District                                                                                                                                                              5
2010 BOND PROGRAM UPDATE

                                EAST VIEW HIGH SCHOOL PHASE 2 ADDITIONS, PACKAGE 2

         Academic Addition                                   Locker Rooms

         Interior View of Orchestra                          Baseball Field
                                                                                     Huckabee
Georgetown Independent School District                                                      6
2010 BOND PROGRAM UPDATE

                           EAST VIEW HIGH SCHOOL PHASE 2 ADDITIONS, PACKAGE 2

                                                   Aerial

                                                                                Huckabee
Georgetown Independent School District                                                 7
2010 BOND PROGRAM UPDATE                                                    General Contractor

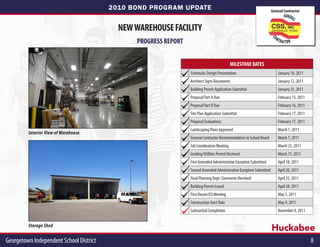

                                           NEW WAREHOUSE FACILITY
                                               PROGRESS REPORT

                                                                                            MILESTONE DATES
                                                                 Schematic Design Presentation                           January 10, 2011
                                                                 Architect Signs Documents                               January 12, 2011
                                                                 Building Permit Application Submittal                   January 25, 2011
                                                                 Proposal Part A Due                                     February 15, 2011
                                                                 Proposal Part B Due                                     February 16, 2011
                                                                 Site Plan Application Submittal                         February 17, 2011
                                                                 Proposal Evaluations                                    February 17, 2011
                                                                 Landscaping Plans Approved                              March 1, 2011
         Interior View of Warehouse
                                                                 General Contractor Recommendation to School Board       March 7, 2011
                                                                 Job Coordination Meeting                                March 25, 2011
                                                                 Grading/Utilities Permit Received                       March 31, 2011
                                                                 First Amended Administrative Exception Submitted        April 18, 2011
                                                                 Second Amended Administrative Exception Submitted       April 20, 2011
                                                                 Final Planning Dept. Comments Received                  April 25, 2011
                                                                 Building Permit Issued                                  April 28, 2011
                                                                 First Owner/CO Meeting                                  May 5, 2011
                                                                 Construction Start Date                                 May 9, 2011
                                                                 Substantial Completion                                  November 9, 2011

         Storage Shed
                                                                                                                     Huckabee
Georgetown Independent School District                                                                                                       8
2010 BOND PROGRAM UPDATE                                                           General Contractor

                     ANNIE PURL ELEMENTARY SCHOOL ROOF AND HVAC MODIFICATIONS
                                                Contract Amount: $229,000

                                                                                                      MILESTONE DATES
                                                                            Schematic Design Presentation                        January 10, 2011
                                                                            Architect Signs Documents                            February 3, 2011
                                                                            Pre-Proposal Meeting                                 February 9, 2011
                                                                            Proposal Part A Due                                  February 22, 2011
                                                                            Proposal Part B Due                                  February 23, 2011
                                                                            Proposal Evaluations                                 February 24, 2011
                                                                            Building Permit Issued                               March 2, 2011
                                                                            General Contractor Recommended to School Board       March 7, 2011
         New HVAC Unit and Roofing
                                                                            First Owner/CO Meeting                               May 24, 2011
                                                                            Construction Start Date                              June 6, 2011
                                                                            Substantial Completion                               August 12, 2011

         New Ceiling and Light Fixtures
                                                                                                                             Huckabee
Georgetown Independent School District                                                                                                               9
2010 BOND PROGRAM UPDATE                                                                                                   Construction Manager

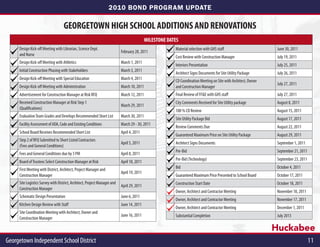

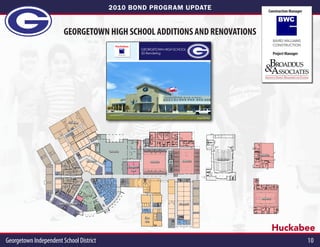

                          GEORGETOWN HIGH SCHOOL ADDITIONS AND RENOVATIONS
                                                                                                                                                                                                       BAIRD WILLIAMS
                                                                             Huckabee                                                                                                                  CONSTRUCTION
                                                                                                               GEORGETOWN HIGH SCHOOL
                                                                                   BAIRD WILLIAMS
                                                                                   CONSTRUCTION
                                                                                                               3D Rendering                                                                            Project Manager

                                                                                                                                                 Front Entry
                                                       Boards.indd 4                                                                                       7/26/11 8:55 AM

                              CTE Wing

                                                                       Cafeteria
                                                                                                                                                                                          Athletics
                                                                                                                                                                             Auditorium
                                            Academic                                                                   Athletics     Athletics
                                                                                                    Computer
                                                                                                      Labs
                              Science
                               Labs

                                          Library
                                                                                                                                                                                           Athletics
                      Special Education                                                                                            Academic

                                                                                                                Fine
                                                                                                                Arts

                                                                                                                                                                                                       Huckabee
Georgetown Independent School District                                                                                                                                                                                   10
2010 BOND PROGRAM UPDATE

                                   GEORGETOWN HIGH SCHOOL ADDITIONS AND RENOVATIONS
                                     MILESTONE DATES                                        MILESTONE DATES
     Design Kick-off Meeting with Librarian, Science Dept.                                               Material selection with GHS staff                        June 30, 2011
                                                                           February 28, 2011
     and Nurse                                                                                           Cost Review with Construction Manager                    July 19, 2011
     Design Kick-off Meeting with Athletics                                March 1, 2011
                                                                                                         Interiors Presentation                                   July 25, 2011
     Initial Construction Phasing with Stakeholders                        March 3, 2011
                                                                                                         Architect Signs Documents for Site Utility Package       July 26, 2011
     Design Kick-off Meeting with Special Education                        March 4, 2011                 CD Coordination Meeting on Site with Architect, Owner
                                                                                                                                                                  July 27, 2011
     Design Kick-off Meeting with Administration                           March 10, 2011                and Construction Manager
     Advertisement for Construction Manager at Risk RFQ                    March 12, 2011                Final Review of FF&E with GHS staff                      July 27, 2011
     Received Construction Manager at Risk Step 1                                                        City Comments Received for Site Utility package          August 8, 2011
                                                                           March 29, 2011
     (Qualifications)                                                                                    100 % CD Review                                          August 15, 2011
     Evaluation Team Grades and Develops Recommended Short List            March 30, 2011
                                                                                                         Site Utility Package Bid                                 August 17, 2011
     Facility Assessment of ADA, Code and Existing Conditions              March 29 - 30, 2011
                                                                                                         Review Comments Due                                      August 22, 2011
     School Board Receives Recommended Short List                          April 4, 2011
                                                                                                         Guaranteed Maximum Price on Site Utility Package         August 29, 2011
     Step 2 of RFQ Submitted to Short Listed Contractors
                                                                           April 5, 2011                 Architect Signs Documents                                September 1, 2011
     (Fees and General Conditions)
                                                                                                         Pre-Bid                                                  September 21, 2011
     Fees and General Conditions due by 3 PM                               April 8, 2011
                                                                                                         Pre-Bid (Technology)                                     September 23, 2011
     Board of Trustees Select Construction Manager at Risk                 April 18, 2011
     First Meeting with District, Architect, Project Manager and                                         Bid                                                      October 4, 2011
                                                                           April 19, 2011
     Construction Manager                                                                                Guaranteed Maximum Price Presented to School Board       October 17, 2011
     Site Logistics Survey with District, Architect, Project Manager and                                 Construction Start Date                                  October 18, 2011
                                                                           April 29, 2011
     Construction Manager
                                                                                                         Owner, Architect and Contractor Meeting                  November 10, 2011
     Schematic Design Presentation                                         June 6, 2011
                                                                                                         Owner, Architect and Contractor Meeting                  November 17, 2011
     Kitchen Design Review with Staff                                      June 14, 2011
                                                                                                         Owner, Architect and Contractor Meeting                  December 1, 2011
     Site Coordination Meeting with Architect, Owner and
                                                                           June 16, 2011                 Substantial Completion                                   July 2013
     Construction Manager

                                                                                                                                                                 Huckabee
Georgetown Independent School District                                                                                                                                                 11
2010 BOND PROGRAM UPDATE

                               GEORGETOWN HIGH SCHOOL ADDITIONS AND RENOVATIONS

     SITE	UTILITY	PACKAGE	–	PHASE	I
     •	 Existing canopy and sidewalks have been removed.
     •	 Sewer	and	storm	drain	main	lines	are	complete	around	the	cafeteria	and
         athletics additions.
     •	 Final	grade	has	been	made	on	the	building	pad	for	the	cafeteria	and
         athletic additions.
     •	 Under-pad	utilities	and	grade	beam	excavation	will	begin	next.
     •	 Interior demolition will begin during the Christmas break.

                                                                                  Site

                                                                                  Transformer and Pad
                                                                                                        Huckabee
Georgetown Independent School District                                                                        12

Huckabee Project Update 12-05-11

  • 1.
    GEORGETOWN ISD 2010 BONDPROGRAM UPDATE D E C E MB E R 2 011 Huckabee
  • 2.
    2010 BOND PROGRAMUPDATE TABLE OF CONTENTS East View High School Phase 2 Additions, Package 1 3 East View High School Phase 2 Additions, Package 2 4 New Warehouse Facility 8 Annie Purl Elementary School Roof and HVAC Modifications 9 Georgetown High School Additions and Renovations 10 Huckabee Georgetown Independent School District 2
  • 3.
    2010 BOND PROGRAMUPDATE General Contractor EAST VIEW HIGH SCHOOL PHASE 2 ADDITIONS, PACKAGE 1 PROGRESS REPORT MILESTONE DATES Schematic Design Presentation November 11, 2010 Architect Signs Documents November 24, 2010 Pre-Proposal Meeting December 8, 2010 Proposal Part A Due December 21, 2010 Proposal Part B Due December 22, 2010 Proposal Evaluations January 4, 2011 General Contractor Recommendation to School Board January 10, 2011 First Owner/CO Meeting February 15, 2011 Field House Locker Room Construction Start Date February 18, 2011 Building Permit Issued March 16, 2011 Owner, Architect and Contractor Meeting June 7, 2011 Owner, Architect and Contractor Meeting June 21, 2011 Owner, Architect and Contractor Meeting July 5, 2011 Owner, Architect and Contractor Meeting July 19, 2011 Substantial Completion (Field/Track and Bleachers) August 1, 2011 Owner, Architect and Contractor Meeting August 2, 2011 Owner, Architect and Contractor Meeting August 16, 2011 Substantial Completion (Buildings) August 19, 2011 Field House Weight Room Huckabee Georgetown Independent School District 3
  • 4.
    2010 BOND PROGRAMUPDATE General Contractor EAST VIEW HIGH SCHOOL PHASE 2 ADDITIONS, PACKAGE 2 Original: $25,574,000 I CATE Addition – $2,121,338 I J Baseball & Softball Turf - $880,000 New Athletic Addition H H Total - $28,575,338 F G J H J First Floor Bid Package 1 A B J Existing East View J High School B A. New Athletic Addition B. New Fine Arts Addition New Fine Arts Addition D E C. New Academic Addition C D. New CTE Building New Academic Addition E. New ROTC Addition (Alt.) CR 10 F. New Tennis Courts 4 ay 29 G. New Tennis Building hw Hig H. New Baseball/Softball Fieldhouse, Bleachers, Lighting & Pressbox I. New Practice Fields J. New Parking (1,070 spaces) New Academic Addition CTE Building Second Floor New CTE/ROTC Addition Academic Wing Softball Field House Huckabee Georgetown Independent School District 4
  • 5.
    2010 BOND PROGRAMUPDATE EAST VIEW HIGH SCHOOL PHASE 2 ADDITIONS, PACKAGE 2 PROGRESS REPORT ACADEMIC ADDITION MILESTONE DATES • Steel structure is making progress. • Overhead utility lines and CMU walls have begun. Schematic Design Presentation January 1, 2011 • 2nd floor slab will begin the end of this week. Architect Signs Documents March 8, 2011 CATE/ROTC Building Permit Application Submittal March 15, 2011 • Underground plumbing and electrical utilities are making progress. • Slab work will resume in January. Site Plan Application Submittal March 17, 2011 • After slab work is complete and metal building has arrived, steel structure will begin. Pre-Proposal Meeting March 22, 2011 ATHLETIC ADDITION Tour with General Contractors at East View Ninth Grade Center March 30, 2011 • CMU wall along the existing building is complete. • Steel structure has begun at the locker room area. The gym area will be started after the locker room Proposal Part A Due April 7, 2011 area is complete. Proposal Part B Due April 8, 2011 • CMU walls will begin next. Proposal Evaluations April 11, 2011 FINE ARTS ADDITION – DRAMA • Steel structure and roof structure are complete. Concrete slabs are complete. Received City Building Dept. Plan Review Comments April 14, 2011 • Overhead utility lines have begun. General Contractor Recommendation to School Board April 18, 2011 • Metal decking and roofing will begin next. Received City Planning Dept. Plan Review Comments April 25, 2011 FINE ARTS ADDITION – ORCHESTRA • CMU walls are complete. Construction Start Date May 19, 2011 • Interior metal stud framing has begun. First Owner/CO Meeting May 24, 2011 • Roofing has begun. Building Permit Issued June 1, 2011 BASEBALL, SOFTBALL, TENNIS AND SITE • CMU walls at field house are nearly complete. Mezzanine slab is in place. Owner, Architect and Contractor Meeting November 8, 2011 • CMU walls have been started at each press box. Roofs for press boxes, dugouts, and tennis building Owner, Architect and Contractor Meeting November 15, 2011 will begin this week. • Fencing and netting is being installed around the fields. Grading at both fields is making progress. Owner, Architect and Contractor Meeting November 22, 2011 • Grandstands will arrive mid-December and are scheduled to be completed by the end of December. • Cutting and grading of parking lots and drives continues. Concrete walks will begin this week. Owner, Architect and Contractor Meeting November 29, 2011 • Grading and cutting for the tennis courts has been started. Substantial Completion June 27, 2012 Huckabee Georgetown Independent School District 5
  • 6.
    2010 BOND PROGRAMUPDATE EAST VIEW HIGH SCHOOL PHASE 2 ADDITIONS, PACKAGE 2 Academic Addition Locker Rooms Interior View of Orchestra Baseball Field Huckabee Georgetown Independent School District 6
  • 7.
    2010 BOND PROGRAMUPDATE EAST VIEW HIGH SCHOOL PHASE 2 ADDITIONS, PACKAGE 2 Aerial Huckabee Georgetown Independent School District 7
  • 8.
    2010 BOND PROGRAMUPDATE General Contractor NEW WAREHOUSE FACILITY PROGRESS REPORT MILESTONE DATES Schematic Design Presentation January 10, 2011 Architect Signs Documents January 12, 2011 Building Permit Application Submittal January 25, 2011 Proposal Part A Due February 15, 2011 Proposal Part B Due February 16, 2011 Site Plan Application Submittal February 17, 2011 Proposal Evaluations February 17, 2011 Landscaping Plans Approved March 1, 2011 Interior View of Warehouse General Contractor Recommendation to School Board March 7, 2011 Job Coordination Meeting March 25, 2011 Grading/Utilities Permit Received March 31, 2011 First Amended Administrative Exception Submitted April 18, 2011 Second Amended Administrative Exception Submitted April 20, 2011 Final Planning Dept. Comments Received April 25, 2011 Building Permit Issued April 28, 2011 First Owner/CO Meeting May 5, 2011 Construction Start Date May 9, 2011 Substantial Completion November 9, 2011 Storage Shed Huckabee Georgetown Independent School District 8
  • 9.
    2010 BOND PROGRAMUPDATE General Contractor ANNIE PURL ELEMENTARY SCHOOL ROOF AND HVAC MODIFICATIONS Contract Amount: $229,000 MILESTONE DATES Schematic Design Presentation January 10, 2011 Architect Signs Documents February 3, 2011 Pre-Proposal Meeting February 9, 2011 Proposal Part A Due February 22, 2011 Proposal Part B Due February 23, 2011 Proposal Evaluations February 24, 2011 Building Permit Issued March 2, 2011 General Contractor Recommended to School Board March 7, 2011 New HVAC Unit and Roofing First Owner/CO Meeting May 24, 2011 Construction Start Date June 6, 2011 Substantial Completion August 12, 2011 New Ceiling and Light Fixtures Huckabee Georgetown Independent School District 9
  • 10.
    2010 BOND PROGRAMUPDATE Construction Manager GEORGETOWN HIGH SCHOOL ADDITIONS AND RENOVATIONS BAIRD WILLIAMS Huckabee CONSTRUCTION GEORGETOWN HIGH SCHOOL BAIRD WILLIAMS CONSTRUCTION 3D Rendering Project Manager Front Entry Boards.indd 4 7/26/11 8:55 AM CTE Wing Cafeteria Athletics Auditorium Academic Athletics Athletics Computer Labs Science Labs Library Athletics Special Education Academic Fine Arts Huckabee Georgetown Independent School District 10
  • 11.
    2010 BOND PROGRAMUPDATE GEORGETOWN HIGH SCHOOL ADDITIONS AND RENOVATIONS MILESTONE DATES MILESTONE DATES Design Kick-off Meeting with Librarian, Science Dept. Material selection with GHS staff June 30, 2011 February 28, 2011 and Nurse Cost Review with Construction Manager July 19, 2011 Design Kick-off Meeting with Athletics March 1, 2011 Interiors Presentation July 25, 2011 Initial Construction Phasing with Stakeholders March 3, 2011 Architect Signs Documents for Site Utility Package July 26, 2011 Design Kick-off Meeting with Special Education March 4, 2011 CD Coordination Meeting on Site with Architect, Owner July 27, 2011 Design Kick-off Meeting with Administration March 10, 2011 and Construction Manager Advertisement for Construction Manager at Risk RFQ March 12, 2011 Final Review of FF&E with GHS staff July 27, 2011 Received Construction Manager at Risk Step 1 City Comments Received for Site Utility package August 8, 2011 March 29, 2011 (Qualifications) 100 % CD Review August 15, 2011 Evaluation Team Grades and Develops Recommended Short List March 30, 2011 Site Utility Package Bid August 17, 2011 Facility Assessment of ADA, Code and Existing Conditions March 29 - 30, 2011 Review Comments Due August 22, 2011 School Board Receives Recommended Short List April 4, 2011 Guaranteed Maximum Price on Site Utility Package August 29, 2011 Step 2 of RFQ Submitted to Short Listed Contractors April 5, 2011 Architect Signs Documents September 1, 2011 (Fees and General Conditions) Pre-Bid September 21, 2011 Fees and General Conditions due by 3 PM April 8, 2011 Pre-Bid (Technology) September 23, 2011 Board of Trustees Select Construction Manager at Risk April 18, 2011 First Meeting with District, Architect, Project Manager and Bid October 4, 2011 April 19, 2011 Construction Manager Guaranteed Maximum Price Presented to School Board October 17, 2011 Site Logistics Survey with District, Architect, Project Manager and Construction Start Date October 18, 2011 April 29, 2011 Construction Manager Owner, Architect and Contractor Meeting November 10, 2011 Schematic Design Presentation June 6, 2011 Owner, Architect and Contractor Meeting November 17, 2011 Kitchen Design Review with Staff June 14, 2011 Owner, Architect and Contractor Meeting December 1, 2011 Site Coordination Meeting with Architect, Owner and June 16, 2011 Substantial Completion July 2013 Construction Manager Huckabee Georgetown Independent School District 11
  • 12.
    2010 BOND PROGRAMUPDATE GEORGETOWN HIGH SCHOOL ADDITIONS AND RENOVATIONS SITE UTILITY PACKAGE – PHASE I • Existing canopy and sidewalks have been removed. • Sewer and storm drain main lines are complete around the cafeteria and athletics additions. • Final grade has been made on the building pad for the cafeteria and athletic additions. • Under-pad utilities and grade beam excavation will begin next. • Interior demolition will begin during the Christmas break. Site Transformer and Pad Huckabee Georgetown Independent School District 12
