Russell Pavlicek
Xen Project Evangelist
Russell.Pavlicek@XenProject.org
Xen Project 10th Anniversary Status
@RCPavlicek
Skype: russpavlicek
• Linux user since 1995; Linux desktop since 1997
• Linux advocate before I ever saw the software
• Early advocate in DEC, Compaq
• Former columnist for Infoworld, Processor
• Former panelist on The Linux Show
• Wrote book, Embracing Insanity: Open Source Software Development
• Speaker at 40+ conferences
• Currently Xen Project Evangelist employed by Citrix

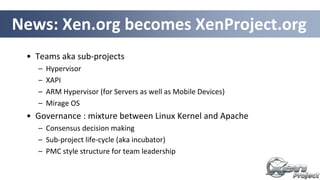

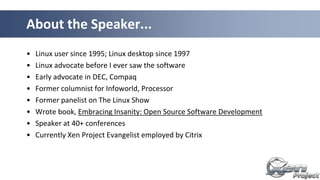

About the Speaker...
• Teams aka sub-projects
– Hypervisor
– XAPI
– ARM Hypervisor (for Servers as well as Mobile Devices)
– Mirage OS
• Governance : mixture between Linux Kernel and Apache
– Consensus decision making
– Sub-project life-cycle (aka incubator)
– PMC style structure for team leadership
News: Xen.org becomes XenProject.org
Why Should I Care about Xen?

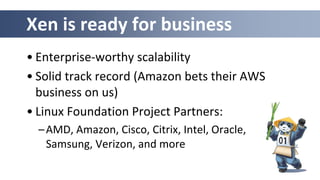

Xen is ready for business
• Enterprise-worthy scalability
• Solid track record (Amazon bets their AWS
business on us)
• Linux Foundation Project Partners:
–AMD, Amazon, Cisco, Citrix, Intel, Oracle,
Samsung, Verizon, and more
Xen contributor community is diversifying
0%
10%
20%
30%
40%
50%
60%
70%
80%
90%
100%
2010 2011 2012
Citrix UPC
SUSE Amazon
University AMD
GridCentric Individual
NSA Intel
Fujitsu iWeb
Misc Oracle
Spectralogic University of British Columbia
• The number of “significant”
active vendors is increasing
• New feature development driving
new participation

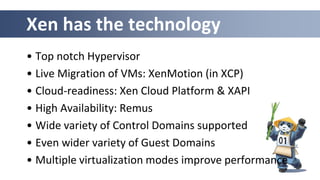

Xen has the technology
• Top notch Hypervisor
• Live Migration of VMs: XenMotion (in XCP)
• Cloud-readiness: Xen Cloud Platform & XAPI
• High Availability: Remus
• Wide variety of Control Domains supported
• Even wider variety of Guest Domains
• Multiple virtualization modes improve performance
Hypervisor Architecture

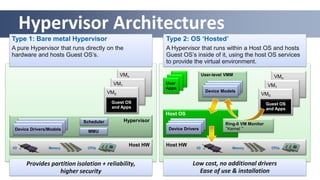

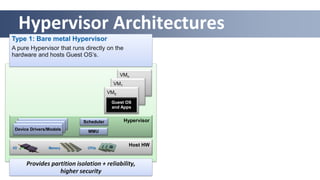

Hypervisor Architectures
Type 1: Bare metal Hypervisor
A pure Hypervisor that runs directly on the
hardware and hosts Guest OS’s.
Provides partition isolation + reliability,
higher security
Host HW
Memory CPUsI/O
HypervisorScheduler
MMUDevice Drivers/Models
VMn
VM1
VM0
Guest OS
and Apps
Hypervisor Architectures
Type 1: Bare metal Hypervisor
A pure Hypervisor that runs directly on the
hardware and hosts Guest OS’s.
Type 2: OS ‘Hosted’
A Hypervisor that runs within a Host OS and hosts
Guest OS’s inside of it, using the host OS services
to provide the virtual environment.
Provides partition isolation + reliability,
higher security
Low cost, no additional drivers
Ease of use & installation
Host HW
Memory CPUsI/O
Host HW
Memory CPUsI/O
HypervisorScheduler
MMUDevice Drivers/Models
VMn
VM1
VM0
Guest OS
and Apps
Host OS
Device Drivers
Ring-0 VM Monitor
“Kernel “
VMn
VM1
VM0
Guest OS
and Apps
User
Apps
User-level VMM
Device Models

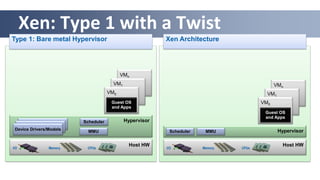

Xen: Type 1 with a Twist
Type 1: Bare metal Hypervisor
Host HW
Memory CPUsI/O
HypervisorScheduler
MMUDevice Drivers/Models
VMn
VM1
VM0
Guest OS
and Apps

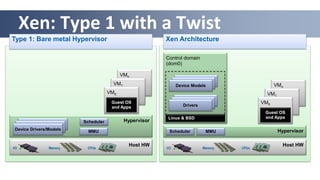

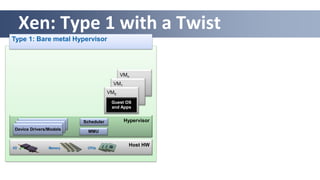

Xen: Type 1 with a Twist
Type 1: Bare metal Hypervisor
Host HW
Memory CPUsI/O
HypervisorScheduler
MMUDevice Drivers/Models
VMn
VM1
VM0
Guest OS
and Apps
Host HW
Memory CPUsI/O
Hypervisor
VMn
VM1
VM0
Guest OS
and Apps
Xen Architecture
Scheduler MMU
Xen: Type 1 with a Twist
Type 1: Bare metal Hypervisor
Host HW
Memory CPUsI/O
HypervisorScheduler
MMUDevice Drivers/Models
VMn
VM1
VM0
Guest OS
and Apps
Host HW
Memory CPUsI/O
Hypervisor
VMn
VM1
VM0
Guest OS
and Apps
Xen Architecture
Scheduler MMU
Control domain
(dom0)
Drivers
Device Models
Linux & BSD
Xen Project and Linux
• Xen Hypervisor is not in the Linux kernel
• BUT: everything Xen and Xen Guests need to run is!
• Xen packages are in all Linux distros (except RHEL6)
– Install Control Domain (Dom0) Linux distribution
– Install Xen package(s) or meta package
– Reboot
– Configure stuff: set up disks, peripherals, etc.
More info: wiki.xenproject.org/wiki/Category:Host_Install

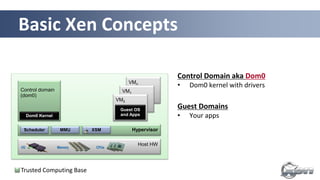

Basic Xen Concepts
15
Control domain
(dom0)
Host HW
VMn
VM1
VM0
Guest OS
and Apps
Memory CPUsI/O
Console
• Interface to the outside world
Control Domain aka Dom0
• Dom0 kernel with drivers
• Xen Management Toolstack
Guest Domains
• Your apps
Driver/Stub/Service Domain(s)
• A “driver, device model or control
service in a box”
• De-privileged and isolated
• Lifetime: start, stop, kill
Dom0 Kernel
HypervisorScheduler MMU XSM
Trusted Computing Base

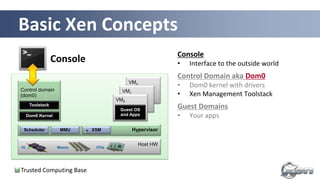

Basic Xen Concepts
16
Control domain
(dom0)
Host HW
VMn
VM1
VM0
Guest OS
and Apps
Console
Memory CPUsI/O
Dom0 Kernel
Toolstack
HypervisorScheduler MMU XSM
Console
• Interface to the outside world
Control Domain aka Dom0
• Dom0 kernel with drivers
• Xen Management Toolstack
Guest Domains
• Your apps
Driver/Stub/Service Domain(s)
• A “driver, device model or control
service in a box”
• De-privileged and isolated
• Lifetime: start, stop, kill
Trusted Computing Base

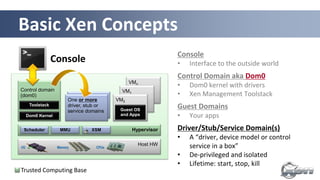

Basic Xen Concepts
17
Control domain
(dom0)
Host HW
VMn
VM1
VM0
Guest OS
and Apps
Console
Memory CPUsI/O
One or more
driver, stub or
service domains
Dom0 Kernel
Toolstack
HypervisorScheduler MMU XSM
Console
• Interface to the outside world
Control Domain aka Dom0
• Dom0 kernel with drivers
• Xen Management Toolstack
Guest Domains
• Your apps
Driver/Stub/Service Domain(s)
• A “driver, device model or control
service in a box”
• De-privileged and isolated
• Lifetime: start, stop, kill
Trusted Computing Base
18

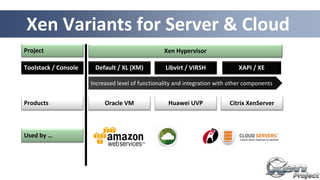

Xen Variants for Server & Cloud
Xen HypervisorHypervisor
Single Host
Basic Functions
Multiple Hosts
Additional Functionality
19

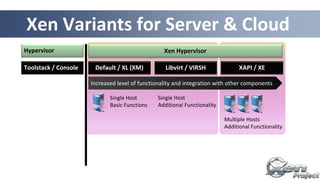

Xen Variants for Server & Cloud
Increased level of functionality and integration with other components
Default / XL (XM)Toolstack / Console Libvirt / VIRSH XAPI / XE
Hypervisor
Single Host
Additional Functionality
Xen Hypervisor
Single Host
Basic Functions
Multiple Hosts
Additional Functionality
Xen Variants for Server & Cloud
Increased level of functionality and integration with other components
Default / XL (XM)Toolstack / Console Libvirt / VIRSH XAPI / XE
Hypervisor
Single Host
Additional Functionality
Xen Hypervisor
21

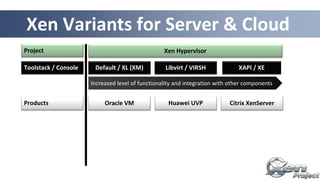

Xen Variants for Server & Cloud
Increased level of functionality and integration with other components
Default / XL (XM)Toolstack / Console Libvirt / VIRSH
Products Oracle VM Huawei UVP Citrix XenServer
Project
XAPI / XE
Xen Hypervisor
22
Xen Variants for Server & Cloud
Increased level of functionality and integration with other components
Default / XL (XM)Toolstack / Console Libvirt / VIRSH
Used by …
Project
XAPI / XE
Products Oracle VM Huawei UVP Citrix XenServer
Xen Hypervisor
Xen : Types of Virtualization

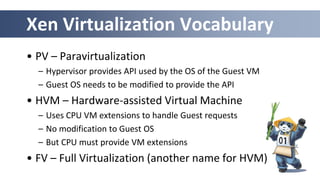

Xen Virtualization Vocabulary
• PV – Paravirtualization
– Hypervisor provides API used by the OS of the Guest VM
– Guest OS needs to be modified to provide the API
• HVM – Hardware-assisted Virtual Machine
– Uses CPU VM extensions to handle Guest requests
– No modification to Guest OS
– But CPU must provide VM extensions
• FV – Full Virtualization (another name for HVM)
Xen Virtualization Vocabulary

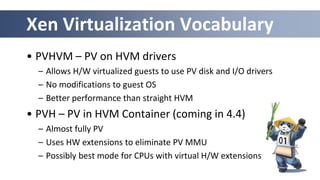

• PVHVM – PV on HVM drivers
– Allows H/W virtualized guests to use PV disk and I/O drivers
– No modifications to guest OS
– Better performance than straight HVM
• PVH – PV in HVM Container (coming in 4.4)
– Almost fully PV
– Uses HW extensions to eliminate PV MMU
– Possibly best mode for CPUs with virtual H/W extensions
26

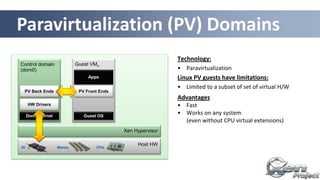

Xen Hypervisor
Control domain
(dom0)
Host HW
Guest VMn
Apps
Memory CPUsI/O
Technology:
• Paravirtualization
Linux PV guests have limitations:
• Limited to a subset of set of virtual H/W
Advantages
• Fast
• Works on any system
(even without CPU virtual extensions)
HW Drivers
PV Back Ends PV Front Ends
Guest OSDom0 Kernel
Paravirtualization (PV) Domains

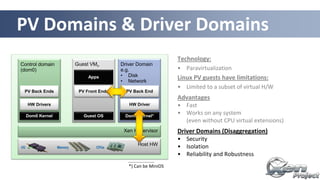

27
Xen Hypervisor
Control domain
(dom0)
Host HW
Guest VMn
Apps
Memory CPUsI/O
Technology:
• Paravirtualization
Linux PV guests have limitations:
• Limited to a subset of virtual H/W
Advantages
• Fast
• Works on any system
(even without CPU virtual extensions)
Driver Domains (Disaggregation)
• Security
• Isolation
• Reliability and Robustness
HW Drivers
PV Back Ends PV Front Ends
Driver Domain
e.g.
• Disk
• Network
HW Driver
PV Back End
Dom0 Kernel*
*) Can be MiniOS
Guest OSDom0 Kernel
PV Domains & Driver Domains
28

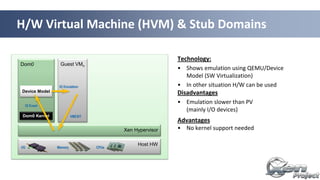

Xen Hypervisor
Dom0
Host HW
Guest VMn
Technology:
• Shows emulation using QEMU/Device
Model (SW Virtualization)
• In other situation H/W can be used
Disadvantages
• Emulation slower than PV
(mainly I/O devices)
Advantages
• No kernel support needed
Device Model
IO Emulation
IO Event
VMEXITDom0 Kernel
H/W Virtual Machine (HVM) & Stub Domains
Memory CPUsI/O
29
Xen Hypervisor
Dom0
Host HW
Guest VMn
Technology:
• Shows emulation using QEMU/Device
Model (SW Virtualization)
• In other situation H/W can be used
Disadvantages
• Emulation slower than PV
(mainly I/O devices)
Advantages
• No kernel support needed

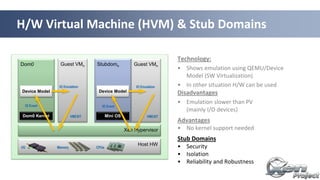

Stub Domains
• Security
• Isolation
• Reliability and Robustness
Device Model
IO Emulation
IO Event
VMEXIT
Stubdomn
Device Model
Mini OS
Guest VMn
IO Emulation
IO Event
VMEXITDom0 Kernel
H/W Virtual Machine (HVM) & Stub Domains
Memory CPUsI/O

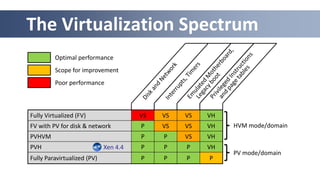

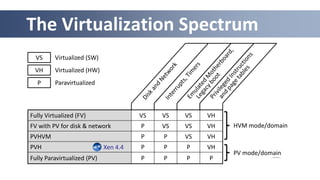

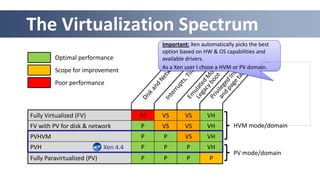

The Virtualization Spectrum
Fully Virtualized (FV) VS VS VS VH
FV with PV for disk & network P VS VS VH
PVHVM P P VS VH
PVH P P P VH
Fully Paravirtualized (PV) P P P P
VH Virtualized (HW)
P Paravirtualized
VS Virtualized (SW)
HVM mode/domain
PV mode/domain
Xen 4.4
The Virtualization Spectrum
Fully Virtualized (FV) VS VS VS VH
FV with PV for disk & network P VS VS VH
PVHVM P P VS VH
PVH P P P VH
Fully Paravirtualized (PV) P P P P
Scope for improvement
Poor performance
Optimal performance
HVM mode/domain
Xen 4.4
PV mode/domain
The Virtualization Spectrum
Fully Virtualized (FV) VS VS VS VH
FV with PV for disk & network P VS VS VH
PVHVM P P VS VH
PVH P P P VH
Fully Paravirtualized (PV) P P P P
Scope for improvement
Poor performance
Optimal performance
HVM mode/domain
Xen 4.4
PV mode/domain
Important: Xen automatically picks the best
option based on HW & OS capabilities and
available drivers.
As a Xen user I chose a HVM or PV domain.

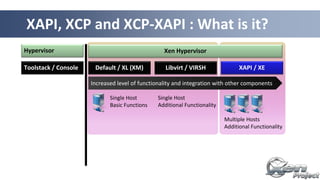

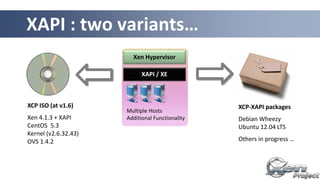

XAPI, XCP and XCP-XAPI
Single Host
Basic Functions
Multiple Hosts
Additional Functionality
XAPI, XCP and XCP-XAPI : What is it?
Increased level of functionality and integration with other components
Default / XL (XM)Toolstack / Console Libvirt / VIRSH XAPI / XE
Hypervisor
Single Host
Additional Functionality
Xen Hypervisor

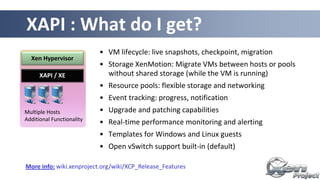

XAPI : What do I get?
Multiple Hosts
Additional Functionality
XAPI / XE
Xen Hypervisor
• VM lifecycle: live snapshots, checkpoint, migration
• Storage XenMotion: Migrate VMs between hosts or pools
without shared storage (while the VM is running)
• Resource pools: flexible storage and networking
• Event tracking: progress, notification
• Upgrade and patching capabilities
• Real-time performance monitoring and alerting
• Templates for Windows and Linux guests
• Open vSwitch support built-in (default)
More info: wiki.xenproject.org/wiki/XCP_Release_Features
XAPI : two variants…
Multiple Hosts
Additional Functionality
XAPI / XE
Xen Hypervisor
XCP ISO (at v1.6)
Xen 4.1.3 + XAPI
CentOS 5.3
Kernel (v2.6.32.43)
OVS 1.4.2
XCP-XAPI packages
Debian Wheezy
Ubuntu 12.04 LTS
Others in progress …
XAPI : Orchestration and UIs
Multiple Hosts
Additional Functionality
XAPI / XE
Xen Hypervisor
Challenges for FOSS hypervisors
“Security and QoS/Reliability are amongst
the top 3 blockers for cloud adoption”
www.colt.net/cio-research
System characteristics cloud users care about:
“Robustness, Performance, Scalability & Security”

Results XCP User Survey 2012 – 90% of users quoted these as most important attributes
Split Control Domain into Driver,
Stub and Service Domains
– See: ”Breaking up is hard to do” @ Xen Papers
– See: “Domain 0 Disaggregation for XCP and XenServer”
Used today by Qubes OS and Citrix XenClient XT
Prototypes for XAPI
Disaggregation
See qubes-os.org
Different windows run
in different VMs
More Security
Increased serviceability and flexibility
Better Robustness
Better Performance
Better Scalability
Benefits of Disaggregation
Ability to safely restart parts of the system
(e.g. just 275ms outage from failed Ethernet driver)
Next: XAPI Architecture Diagram

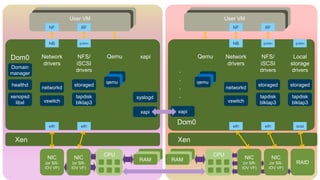

Before and After Disaggregation
CPUCPU
RAM RAMNIC
(or SR-
IOV VF)
NIC
(or SR-
IOV VF)
NIC
(or SR-
IOV VF)
NIC
(or SR-
IOV VF)
RAID
Xen
Dom0Network
drivers
NFS/
iSCSI
drivers
Qemu xapi Local
storage
drivers
NFS/
iSCSI
drivers
Network
drivers
Qemu
eth eth eth eth scsi
User VM User VM
NB gntdev NB
NF BF NF BF
qemu qemu
xapi
vswitch
networkd
tapdisk
blktap3
storaged
syslogd
vswitch
networkd
tapdisk
blktap3
storaged
tapdisk
blktap3
storaged
gntdev gntdev
Dom0
xenopsd
libxl
healthd
Domain
manager
Dom0
.
.
.
.
Xen
xapi
CPUCPU
RAM RAMNIC
(or SR-
IOV VF)
NIC
(or SR-
IOV VF)
NIC
(or SR-
IOV VF)
NIC
(or SR-
IOV VF)
RAID
Dom0 Network
driver
domain
NFS/
iSCSI
driver
domain
Qemu
domain
xapi
domain
Logging
domain
Local
storage
driver
domain
NFS/
iSCSI
driver
domain
Network
driver
domain
User VM User VM
NB gntdev NB
NF BF NF BF
dbus over v4v
qemu
xapi
xenopsd
libxl
healthd
Domain
manager
vswitch
networkd
tapdisk
blktap3
storaged
syslogd vswitch
networkd
tapdisk
blktap3
storaged
tapdisk
blktap3
storaged
gntdev gntdev
eth eth eth eth scsi
Xen Xen
D
o
m
0
dbus over v4v
.
.
.
46
Xen Security Advantages
• Even without Advanced Security Features
– Well-defined trusted computing base (much smaller than on type-2 HV)
– Minimal services in hypervisor layer
• Xen Security Modules (or XSM) and FLASK
– XSM is Xen equivalent of LSM
– FLASK is Xen equivalent of SELinux
– Developed, maintained and contributed to Xen by NSA
– Compatible with SELinux (tools, architecture)
– XSM object classes maps onto Xen features
More info: http://www.slideshare.net/xen_com_mgr/
a-brief-tutorial-on-xens-advanced-security-features
CPUCPU
RAM RAMNIC
(or SR-
IOV VF)
NIC
(or SR-
IOV VF)
NIC
(or SR-
IOV VF)
NIC
(or SR-
IOV VF)
RAID
Xen
Dom0 Network
driver
domain
NFS/
iSCSI
driver
domain
Qemu
domain
xapi
domain
Logging
domain
Local
storage
driver
domain
NFS/
iSCSI
driver
domain
Network
driver
domain
eth eth eth eth scsi
User VM User VM
NB gntdev NB
NF BF NF BF
qemu
xapi
xenopsd
libxl
healthd
Domain
manager
vswitch
networkd
tapdisk
blktap3
storaged
syslogd vswitch
networkd
tapdisk
blktap3
storaged
tapdisk
blktap3
storaged
gntdev gntdev
FLASK policy
restricting access
D
o
m
0
.
.
.
dbus over v4v dbus over v4v
Xen
ARM Hypervisor
Fully functional for ARM v7 & v8
ARM v7: Versatile Express, Arndale &
Samsung Chromebook
ARM v8: Fast Model
Xen 4.3 for ARM Servers
ARM SOC
Xen + ARM = a perfect Match
ARM Architecture Features for Virtualization
Hypervisor mode : EL2
Kernel mode : EL1
User mode : EL0
GIC
v2
GT
2 stage
MMU
I/O

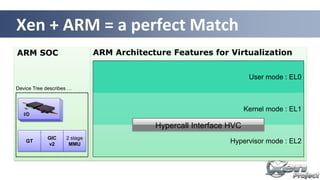

Device Tree describes …
Hypercall Interface HVC
ARM SOC ARM Architecture Features for Virtualization
EL2
EL1
EL0
GIC
v2
GT
2 stage
MMU
I/O
Device Tree describes …
HVC
Xen + ARM = a perfect Match
Xen Hypervisor

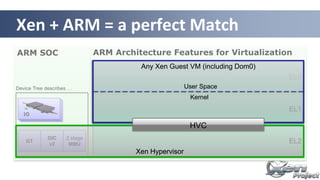

ARM SOC ARM Architecture Features for Virtualization
EL2
EL1
EL0
GIC
v2
GT
2 stage
MMU
I/O
Device Tree describes …
HVC
Xen + ARM = a perfect Match
Xen Hypervisor
Any Xen Guest VM (including Dom0)
Kernel
User Space
HVC

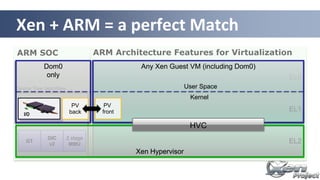

ARM SOC ARM Architecture Features for Virtualization
EL2
EL1
EL0
GIC
v2
GT
2 stage
MMU
I/O
Device Tree describes …
HVC
Xen + ARM = a perfect Match
Xen Hypervisor
Dom0
only
Any Xen Guest VM (including Dom0)
Kernel
User Space
I/O
PV
back
PV
frontI/O
HVC

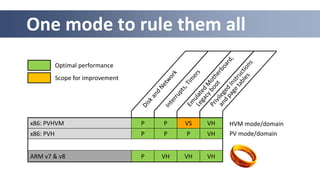

One mode to rule them all
x86: PVHVM P P VS VH
x86: PVH P P P VH
ARM v7 & v8 P VH VH VH
Scope for improvement
Optimal performance
HVM mode/domain
PV mode/domain

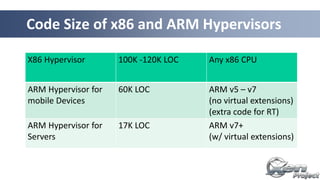

Code Size of x86 and ARM Hypervisors
X86 Hypervisor 100K -120K LOC Any x86 CPU
ARM Hypervisor for
mobile Devices
60K LOC ARM v5 – v7
(no virtual extensions)
(extra code for RT)
ARM Hypervisor for
Servers
17K LOC ARM v7+
(w/ virtual extensions)

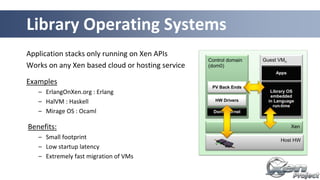

Mirage OS
Application stacks only running on Xen APIs
Works on any Xen based cloud or hosting service
Examples
– ErlangOnXen.org : Erlang
– HalVM : Haskell
– Mirage OS : Ocaml
Benefits:
– Small footprint
– Low startup latency
– Extremely fast migration of VMs
Library Operating Systems
Xen
Control domain
(dom0)
Host HW
Guest VMn
Apps
HW Drivers
PV Back Ends
Library OS
embedded
in Language
run-time
Dom0 Kernel
• Recently added to Xen Project incubator
• In beta stage: first release on its way
• Clean-slate protocols implementations, e.g.
– TCP/IP, DNS, SSH, Openflow (switch/controller), HTTP, XMPP, ...
– New applications using next generation XAPI
(disaggregated XAPI architecture)
Mirage OS
More info: http://www.slideshare.net/xen_com_mgr/
mirage-extreme-specialisation-of-virtual-appliances
What’s Next?
• Release Candidate 4 Test Day on 6/12
• Xen ARM for Servers
• Extend scope of Xen Security Modules
• qxl Spice support for 3d acceleration
• Updated and improved libvirt drivers for Xen
• Lots of other stuff:
– scalability, performance, better NUMA support, …
Coming in Xen 4.3 (June 2013)
More info: http://wiki.xenproject.org/wiki/Xen_Roadmap/4.3
• Establish a shared test infrastructure
– Most major contributors are duplicating effort
– Mirage OS provides interesting opportunities
• Usability and better distribution integration
– Example: Xen + XAPI in CentOS 6.4
• More focus on downstreams
– Examples: OpenStack and Xen Orchestra
• Disaggregation in Xen toolstacks (e.g XAPI)
• Better Libvirt and virt-manager integration
– Embed Xen more into the Linux ecosystem and provide benefits for the
wider Linux community
What’s next (and already happening)
• Document Days (monthly)
• Test Days (prior to release)
• Mailing Lists and IRC
• XenProject.org (sign up, it’s free!)
Getting Started with Xen Project
Xen Hackathon & Developer Summit (annually;
vote for next year’s location in the Q&A section
of XenProject.org until June 14, 2013)
Thank You!
Slides available under CC-BY-SA 3.0
From www.slideshare.net/xen_com_mgr
@RCPavlicek
Skype: russpavlicek
• News: blog.XenProject.org
• Web: XenProject.org
– Help for IRC, Lists, …
– Stackoverflow like Q&A
• Wiki: wiki.XenProject.org
• Presentations: slideshare.net/xen_com_mgr
• Videos: vimeo.com/channels/xen

Xen 10th anniversary Status Report (at SELF 2013)

  • 1.
    Russell Pavlicek Xen ProjectEvangelist Russell.Pavlicek@XenProject.org Xen Project 10th Anniversary Status @RCPavlicek Skype: russpavlicek
  • 2.
    • Linux usersince 1995; Linux desktop since 1997 • Linux advocate before I ever saw the software • Early advocate in DEC, Compaq • Former columnist for Infoworld, Processor • Former panelist on The Linux Show • Wrote book, Embracing Insanity: Open Source Software Development • Speaker at 40+ conferences • Currently Xen Project Evangelist employed by Citrix About the Speaker...
  • 3.
    • Teams akasub-projects – Hypervisor – XAPI – ARM Hypervisor (for Servers as well as Mobile Devices) – Mirage OS • Governance : mixture between Linux Kernel and Apache – Consensus decision making – Sub-project life-cycle (aka incubator) – PMC style structure for team leadership News: Xen.org becomes XenProject.org
  • 4.
    Why Should ICare about Xen?
  • 5.
    Xen is readyfor business • Enterprise-worthy scalability • Solid track record (Amazon bets their AWS business on us) • Linux Foundation Project Partners: –AMD, Amazon, Cisco, Citrix, Intel, Oracle, Samsung, Verizon, and more
  • 6.
    Xen contributor communityis diversifying 0% 10% 20% 30% 40% 50% 60% 70% 80% 90% 100% 2010 2011 2012 Citrix UPC SUSE Amazon University AMD GridCentric Individual NSA Intel Fujitsu iWeb Misc Oracle Spectralogic University of British Columbia • The number of “significant” active vendors is increasing • New feature development driving new participation
  • 7.
    Xen has thetechnology • Top notch Hypervisor • Live Migration of VMs: XenMotion (in XCP) • Cloud-readiness: Xen Cloud Platform & XAPI • High Availability: Remus • Wide variety of Control Domains supported • Even wider variety of Guest Domains • Multiple virtualization modes improve performance
  • 8.
  • 9.
    Hypervisor Architectures Type 1:Bare metal Hypervisor A pure Hypervisor that runs directly on the hardware and hosts Guest OS’s. Provides partition isolation + reliability, higher security Host HW Memory CPUsI/O HypervisorScheduler MMUDevice Drivers/Models VMn VM1 VM0 Guest OS and Apps
  • 10.
    Hypervisor Architectures Type 1:Bare metal Hypervisor A pure Hypervisor that runs directly on the hardware and hosts Guest OS’s. Type 2: OS ‘Hosted’ A Hypervisor that runs within a Host OS and hosts Guest OS’s inside of it, using the host OS services to provide the virtual environment. Provides partition isolation + reliability, higher security Low cost, no additional drivers Ease of use & installation Host HW Memory CPUsI/O Host HW Memory CPUsI/O HypervisorScheduler MMUDevice Drivers/Models VMn VM1 VM0 Guest OS and Apps Host OS Device Drivers Ring-0 VM Monitor “Kernel “ VMn VM1 VM0 Guest OS and Apps User Apps User-level VMM Device Models
  • 11.
    Xen: Type 1with a Twist Type 1: Bare metal Hypervisor Host HW Memory CPUsI/O HypervisorScheduler MMUDevice Drivers/Models VMn VM1 VM0 Guest OS and Apps
  • 12.
    Xen: Type 1with a Twist Type 1: Bare metal Hypervisor Host HW Memory CPUsI/O HypervisorScheduler MMUDevice Drivers/Models VMn VM1 VM0 Guest OS and Apps Host HW Memory CPUsI/O Hypervisor VMn VM1 VM0 Guest OS and Apps Xen Architecture Scheduler MMU
  • 13.
    Xen: Type 1with a Twist Type 1: Bare metal Hypervisor Host HW Memory CPUsI/O HypervisorScheduler MMUDevice Drivers/Models VMn VM1 VM0 Guest OS and Apps Host HW Memory CPUsI/O Hypervisor VMn VM1 VM0 Guest OS and Apps Xen Architecture Scheduler MMU Control domain (dom0) Drivers Device Models Linux & BSD
  • 14.
    Xen Project andLinux • Xen Hypervisor is not in the Linux kernel • BUT: everything Xen and Xen Guests need to run is! • Xen packages are in all Linux distros (except RHEL6) – Install Control Domain (Dom0) Linux distribution – Install Xen package(s) or meta package – Reboot – Configure stuff: set up disks, peripherals, etc. More info: wiki.xenproject.org/wiki/Category:Host_Install
  • 15.
    Basic Xen Concepts 15 Controldomain (dom0) Host HW VMn VM1 VM0 Guest OS and Apps Memory CPUsI/O Console • Interface to the outside world Control Domain aka Dom0 • Dom0 kernel with drivers • Xen Management Toolstack Guest Domains • Your apps Driver/Stub/Service Domain(s) • A “driver, device model or control service in a box” • De-privileged and isolated • Lifetime: start, stop, kill Dom0 Kernel HypervisorScheduler MMU XSM Trusted Computing Base
  • 16.
    Basic Xen Concepts 16 Controldomain (dom0) Host HW VMn VM1 VM0 Guest OS and Apps Console Memory CPUsI/O Dom0 Kernel Toolstack HypervisorScheduler MMU XSM Console • Interface to the outside world Control Domain aka Dom0 • Dom0 kernel with drivers • Xen Management Toolstack Guest Domains • Your apps Driver/Stub/Service Domain(s) • A “driver, device model or control service in a box” • De-privileged and isolated • Lifetime: start, stop, kill Trusted Computing Base
  • 17.
    Basic Xen Concepts 17 Controldomain (dom0) Host HW VMn VM1 VM0 Guest OS and Apps Console Memory CPUsI/O One or more driver, stub or service domains Dom0 Kernel Toolstack HypervisorScheduler MMU XSM Console • Interface to the outside world Control Domain aka Dom0 • Dom0 kernel with drivers • Xen Management Toolstack Guest Domains • Your apps Driver/Stub/Service Domain(s) • A “driver, device model or control service in a box” • De-privileged and isolated • Lifetime: start, stop, kill Trusted Computing Base
  • 18.
    18 Xen Variants forServer & Cloud Xen HypervisorHypervisor
  • 19.
    Single Host Basic Functions MultipleHosts Additional Functionality 19 Xen Variants for Server & Cloud Increased level of functionality and integration with other components Default / XL (XM)Toolstack / Console Libvirt / VIRSH XAPI / XE Hypervisor Single Host Additional Functionality Xen Hypervisor
  • 20.
    Single Host Basic Functions MultipleHosts Additional Functionality Xen Variants for Server & Cloud Increased level of functionality and integration with other components Default / XL (XM)Toolstack / Console Libvirt / VIRSH XAPI / XE Hypervisor Single Host Additional Functionality Xen Hypervisor
  • 21.
    21 Xen Variants forServer & Cloud Increased level of functionality and integration with other components Default / XL (XM)Toolstack / Console Libvirt / VIRSH Products Oracle VM Huawei UVP Citrix XenServer Project XAPI / XE Xen Hypervisor
  • 22.
    22 Xen Variants forServer & Cloud Increased level of functionality and integration with other components Default / XL (XM)Toolstack / Console Libvirt / VIRSH Used by … Project XAPI / XE Products Oracle VM Huawei UVP Citrix XenServer Xen Hypervisor
  • 23.
    Xen : Typesof Virtualization
  • 24.
    Xen Virtualization Vocabulary •PV – Paravirtualization – Hypervisor provides API used by the OS of the Guest VM – Guest OS needs to be modified to provide the API • HVM – Hardware-assisted Virtual Machine – Uses CPU VM extensions to handle Guest requests – No modification to Guest OS – But CPU must provide VM extensions • FV – Full Virtualization (another name for HVM)
  • 25.
    Xen Virtualization Vocabulary •PVHVM – PV on HVM drivers – Allows H/W virtualized guests to use PV disk and I/O drivers – No modifications to guest OS – Better performance than straight HVM • PVH – PV in HVM Container (coming in 4.4) – Almost fully PV – Uses HW extensions to eliminate PV MMU – Possibly best mode for CPUs with virtual H/W extensions
  • 26.
    26 Xen Hypervisor Control domain (dom0) HostHW Guest VMn Apps Memory CPUsI/O Technology: • Paravirtualization Linux PV guests have limitations: • Limited to a subset of set of virtual H/W Advantages • Fast • Works on any system (even without CPU virtual extensions) HW Drivers PV Back Ends PV Front Ends Guest OSDom0 Kernel Paravirtualization (PV) Domains
  • 27.
    27 Xen Hypervisor Control domain (dom0) HostHW Guest VMn Apps Memory CPUsI/O Technology: • Paravirtualization Linux PV guests have limitations: • Limited to a subset of virtual H/W Advantages • Fast • Works on any system (even without CPU virtual extensions) Driver Domains (Disaggregation) • Security • Isolation • Reliability and Robustness HW Drivers PV Back Ends PV Front Ends Driver Domain e.g. • Disk • Network HW Driver PV Back End Dom0 Kernel* *) Can be MiniOS Guest OSDom0 Kernel PV Domains & Driver Domains
  • 28.
    28 Xen Hypervisor Dom0 Host HW GuestVMn Technology: • Shows emulation using QEMU/Device Model (SW Virtualization) • In other situation H/W can be used Disadvantages • Emulation slower than PV (mainly I/O devices) Advantages • No kernel support needed Device Model IO Emulation IO Event VMEXITDom0 Kernel H/W Virtual Machine (HVM) & Stub Domains Memory CPUsI/O
  • 29.
    29 Xen Hypervisor Dom0 Host HW GuestVMn Technology: • Shows emulation using QEMU/Device Model (SW Virtualization) • In other situation H/W can be used Disadvantages • Emulation slower than PV (mainly I/O devices) Advantages • No kernel support needed Stub Domains • Security • Isolation • Reliability and Robustness Device Model IO Emulation IO Event VMEXIT Stubdomn Device Model Mini OS Guest VMn IO Emulation IO Event VMEXITDom0 Kernel H/W Virtual Machine (HVM) & Stub Domains Memory CPUsI/O
  • 30.
    The Virtualization Spectrum FullyVirtualized (FV) VS VS VS VH FV with PV for disk & network P VS VS VH PVHVM P P VS VH PVH P P P VH Fully Paravirtualized (PV) P P P P VH Virtualized (HW) P Paravirtualized VS Virtualized (SW) HVM mode/domain PV mode/domain Xen 4.4
  • 31.
    The Virtualization Spectrum FullyVirtualized (FV) VS VS VS VH FV with PV for disk & network P VS VS VH PVHVM P P VS VH PVH P P P VH Fully Paravirtualized (PV) P P P P Scope for improvement Poor performance Optimal performance HVM mode/domain Xen 4.4 PV mode/domain
  • 32.
    The Virtualization Spectrum FullyVirtualized (FV) VS VS VS VH FV with PV for disk & network P VS VS VH PVHVM P P VS VH PVH P P P VH Fully Paravirtualized (PV) P P P P Scope for improvement Poor performance Optimal performance HVM mode/domain Xen 4.4 PV mode/domain Important: Xen automatically picks the best option based on HW & OS capabilities and available drivers. As a Xen user I chose a HVM or PV domain.
  • 33.
    XAPI, XCP andXCP-XAPI
  • 34.
    Single Host Basic Functions MultipleHosts Additional Functionality XAPI, XCP and XCP-XAPI : What is it? Increased level of functionality and integration with other components Default / XL (XM)Toolstack / Console Libvirt / VIRSH XAPI / XE Hypervisor Single Host Additional Functionality Xen Hypervisor
  • 35.
    XAPI : Whatdo I get? Multiple Hosts Additional Functionality XAPI / XE Xen Hypervisor • VM lifecycle: live snapshots, checkpoint, migration • Storage XenMotion: Migrate VMs between hosts or pools without shared storage (while the VM is running) • Resource pools: flexible storage and networking • Event tracking: progress, notification • Upgrade and patching capabilities • Real-time performance monitoring and alerting • Templates for Windows and Linux guests • Open vSwitch support built-in (default) More info: wiki.xenproject.org/wiki/XCP_Release_Features
  • 36.
    XAPI : twovariants… Multiple Hosts Additional Functionality XAPI / XE Xen Hypervisor XCP ISO (at v1.6) Xen 4.1.3 + XAPI CentOS 5.3 Kernel (v2.6.32.43) OVS 1.4.2 XCP-XAPI packages Debian Wheezy Ubuntu 12.04 LTS Others in progress …
  • 37.
    XAPI : Orchestrationand UIs Multiple Hosts Additional Functionality XAPI / XE Xen Hypervisor
  • 38.
  • 39.
    “Security and QoS/Reliabilityare amongst the top 3 blockers for cloud adoption” www.colt.net/cio-research
  • 40.
    System characteristics cloudusers care about: “Robustness, Performance, Scalability & Security” Results XCP User Survey 2012 – 90% of users quoted these as most important attributes
  • 41.
    Split Control Domaininto Driver, Stub and Service Domains – See: ”Breaking up is hard to do” @ Xen Papers – See: “Domain 0 Disaggregation for XCP and XenServer” Used today by Qubes OS and Citrix XenClient XT Prototypes for XAPI Disaggregation See qubes-os.org Different windows run in different VMs
  • 42.
    More Security Increased serviceabilityand flexibility Better Robustness Better Performance Better Scalability Benefits of Disaggregation Ability to safely restart parts of the system (e.g. just 275ms outage from failed Ethernet driver)
  • 43.
    Next: XAPI ArchitectureDiagram Before and After Disaggregation
  • 44.
    CPUCPU RAM RAMNIC (or SR- IOVVF) NIC (or SR- IOV VF) NIC (or SR- IOV VF) NIC (or SR- IOV VF) RAID Xen Dom0Network drivers NFS/ iSCSI drivers Qemu xapi Local storage drivers NFS/ iSCSI drivers Network drivers Qemu eth eth eth eth scsi User VM User VM NB gntdev NB NF BF NF BF qemu qemu xapi vswitch networkd tapdisk blktap3 storaged syslogd vswitch networkd tapdisk blktap3 storaged tapdisk blktap3 storaged gntdev gntdev Dom0 xenopsd libxl healthd Domain manager Dom0 . . . . Xen xapi
  • 45.
    CPUCPU RAM RAMNIC (or SR- IOVVF) NIC (or SR- IOV VF) NIC (or SR- IOV VF) NIC (or SR- IOV VF) RAID Dom0 Network driver domain NFS/ iSCSI driver domain Qemu domain xapi domain Logging domain Local storage driver domain NFS/ iSCSI driver domain Network driver domain User VM User VM NB gntdev NB NF BF NF BF dbus over v4v qemu xapi xenopsd libxl healthd Domain manager vswitch networkd tapdisk blktap3 storaged syslogd vswitch networkd tapdisk blktap3 storaged tapdisk blktap3 storaged gntdev gntdev eth eth eth eth scsi Xen Xen D o m 0 dbus over v4v . . .
  • 46.
    46 Xen Security Advantages •Even without Advanced Security Features – Well-defined trusted computing base (much smaller than on type-2 HV) – Minimal services in hypervisor layer • Xen Security Modules (or XSM) and FLASK – XSM is Xen equivalent of LSM – FLASK is Xen equivalent of SELinux – Developed, maintained and contributed to Xen by NSA – Compatible with SELinux (tools, architecture) – XSM object classes maps onto Xen features More info: http://www.slideshare.net/xen_com_mgr/ a-brief-tutorial-on-xens-advanced-security-features
  • 47.
    CPUCPU RAM RAMNIC (or SR- IOVVF) NIC (or SR- IOV VF) NIC (or SR- IOV VF) NIC (or SR- IOV VF) RAID Xen Dom0 Network driver domain NFS/ iSCSI driver domain Qemu domain xapi domain Logging domain Local storage driver domain NFS/ iSCSI driver domain Network driver domain eth eth eth eth scsi User VM User VM NB gntdev NB NF BF NF BF qemu xapi xenopsd libxl healthd Domain manager vswitch networkd tapdisk blktap3 storaged syslogd vswitch networkd tapdisk blktap3 storaged tapdisk blktap3 storaged gntdev gntdev FLASK policy restricting access D o m 0 . . . dbus over v4v dbus over v4v Xen
  • 48.
  • 49.
    Fully functional forARM v7 & v8 ARM v7: Versatile Express, Arndale & Samsung Chromebook ARM v8: Fast Model Xen 4.3 for ARM Servers
  • 50.
    ARM SOC Xen +ARM = a perfect Match ARM Architecture Features for Virtualization Hypervisor mode : EL2 Kernel mode : EL1 User mode : EL0 GIC v2 GT 2 stage MMU I/O Device Tree describes … Hypercall Interface HVC
  • 51.
    ARM SOC ARMArchitecture Features for Virtualization EL2 EL1 EL0 GIC v2 GT 2 stage MMU I/O Device Tree describes … HVC Xen + ARM = a perfect Match Xen Hypervisor
  • 52.
    ARM SOC ARMArchitecture Features for Virtualization EL2 EL1 EL0 GIC v2 GT 2 stage MMU I/O Device Tree describes … HVC Xen + ARM = a perfect Match Xen Hypervisor Any Xen Guest VM (including Dom0) Kernel User Space HVC
  • 53.
    ARM SOC ARMArchitecture Features for Virtualization EL2 EL1 EL0 GIC v2 GT 2 stage MMU I/O Device Tree describes … HVC Xen + ARM = a perfect Match Xen Hypervisor Dom0 only Any Xen Guest VM (including Dom0) Kernel User Space I/O PV back PV frontI/O HVC
  • 54.
    One mode torule them all x86: PVHVM P P VS VH x86: PVH P P P VH ARM v7 & v8 P VH VH VH Scope for improvement Optimal performance HVM mode/domain PV mode/domain
  • 55.
    Code Size ofx86 and ARM Hypervisors X86 Hypervisor 100K -120K LOC Any x86 CPU ARM Hypervisor for mobile Devices 60K LOC ARM v5 – v7 (no virtual extensions) (extra code for RT) ARM Hypervisor for Servers 17K LOC ARM v7+ (w/ virtual extensions)
  • 56.
  • 57.
    Application stacks onlyrunning on Xen APIs Works on any Xen based cloud or hosting service Examples – ErlangOnXen.org : Erlang – HalVM : Haskell – Mirage OS : Ocaml Benefits: – Small footprint – Low startup latency – Extremely fast migration of VMs Library Operating Systems Xen Control domain (dom0) Host HW Guest VMn Apps HW Drivers PV Back Ends Library OS embedded in Language run-time Dom0 Kernel
  • 58.
    • Recently addedto Xen Project incubator • In beta stage: first release on its way • Clean-slate protocols implementations, e.g. – TCP/IP, DNS, SSH, Openflow (switch/controller), HTTP, XMPP, ... – New applications using next generation XAPI (disaggregated XAPI architecture) Mirage OS More info: http://www.slideshare.net/xen_com_mgr/ mirage-extreme-specialisation-of-virtual-appliances
  • 59.
  • 60.
    • Release Candidate4 Test Day on 6/12 • Xen ARM for Servers • Extend scope of Xen Security Modules • qxl Spice support for 3d acceleration • Updated and improved libvirt drivers for Xen • Lots of other stuff: – scalability, performance, better NUMA support, … Coming in Xen 4.3 (June 2013) More info: http://wiki.xenproject.org/wiki/Xen_Roadmap/4.3
  • 61.
    • Establish ashared test infrastructure – Most major contributors are duplicating effort – Mirage OS provides interesting opportunities • Usability and better distribution integration – Example: Xen + XAPI in CentOS 6.4 • More focus on downstreams – Examples: OpenStack and Xen Orchestra • Disaggregation in Xen toolstacks (e.g XAPI) • Better Libvirt and virt-manager integration – Embed Xen more into the Linux ecosystem and provide benefits for the wider Linux community What’s next (and already happening)
  • 62.
    • Document Days(monthly) • Test Days (prior to release) • Mailing Lists and IRC • XenProject.org (sign up, it’s free!) Getting Started with Xen Project Xen Hackathon & Developer Summit (annually; vote for next year’s location in the Q&A section of XenProject.org until June 14, 2013)
  • 63.
    Thank You! Slides availableunder CC-BY-SA 3.0 From www.slideshare.net/xen_com_mgr @RCPavlicek Skype: russpavlicek • News: blog.XenProject.org • Web: XenProject.org – Help for IRC, Lists, … – Stackoverflow like Q&A • Wiki: wiki.XenProject.org • Presentations: slideshare.net/xen_com_mgr • Videos: vimeo.com/channels/xen
