1
Upstream
Shifting-Left towards Organization Agility
Sudipta Lahiri
Head of Engineering, Digite
2

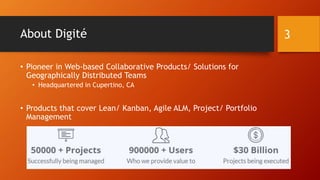

About Digité
• Pioneer in Web-based Collaborative Products/ Solutions for
Geographically Distributed Teams
• Headquartered in Cupertino, CA
• Products that cover Lean/ Kanban, Agile ALM, Project/ Portfolio
Management
3

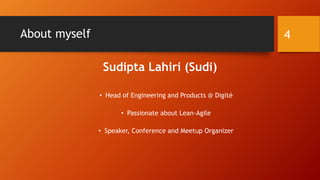

About myself
• Head of Engineering and Products @ Digité
• Passionate about Lean-Agile
• Speaker, Conference and Meetup Organizer
4
Sudipta Lahiri (Sudi)
5
6

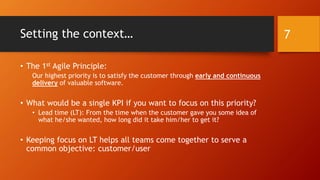

Setting the context…
• The 1st Agile Principle:
Our highest priority is to satisfy the customer through early and continuous
delivery of valuable software.
• What would be a single KPI if you want to focus on this priority?
• Lead time (LT): From the time when the customer gave you some idea of
what he/she wanted, how long did it take him/her to get it?
• Keeping focus on LT helps all teams come together to serve a
common objective: customer/user
7

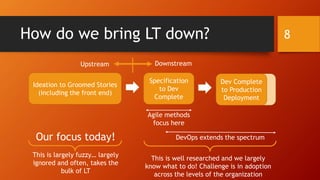

How do we bring LT down?
Ideation to Groomed Stories
(including the front end)
Specification
to Dev
Complete
Dev Complete
to Production
Deployment
Agile methods
focus here
DevOps extends the spectrum
8
This is well researched and we largely
know what to do! Challenge is in adoption
across the levels of the organization
This is largely fuzzy… largely
ignored and often, takes the
bulk of LT
Our focus today!
DownstreamUpstream

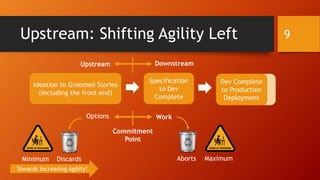

Upstream: Shifting Agility Left
Ideation to Groomed Stories
(including the front end)
Specification
to Dev
Complete
Dev Complete
to Production
Deployment
9
DownstreamUpstream
WorkOptions
Commitment
Point
Discards AbortsMinimum Maximum
Towards Increasing Agility!
Value Streaming Upstream and Downstream
Getting the right set of “groomed” stories
10

11

12

13

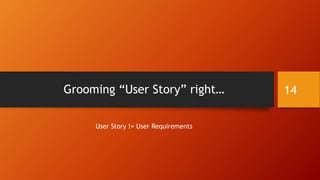

Grooming “User Story” right…
User Story != User Requirements
14
Conventional “Requirements” have failed… 15
16

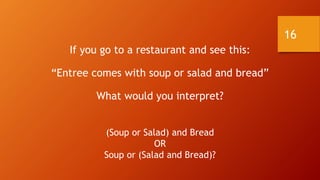

If you go to a restaurant and see this:
“Entree comes with soup or salad and bread”
What would you interpret?
(Soup or Salad) and Bread
OR
Soup or (Salad and Bread)?
17
18

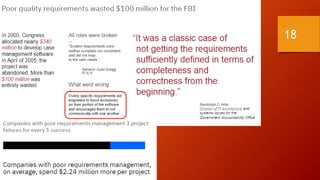

What’s the most common reaction to this? 19

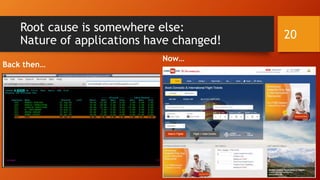

Root cause is somewhere else:
Nature of applications have changed!
Back then…
Now…
20

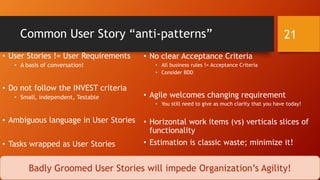

Common User Story “anti-patterns”
• User Stories != User Requirements
• A basis of conversation!
• Do not follow the INVEST criteria
• Small, independent, Testable
• Ambiguous language in User Stories
• Tasks wrapped as User Stories
• No clear Acceptance Criteria
• All business rules != Acceptance Criteria
• Consider BDD
• Agile welcomes changing requirement
• You still need to give as much clarity that you have today!
• Horizontal work items (vs) verticals slices of
functionality
• Estimation is classic waste; minimize it!
21
Badly Groomed User Stories will impede Organization’s Agility!

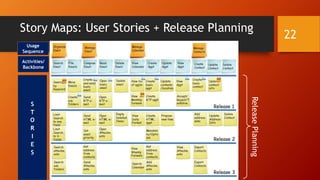

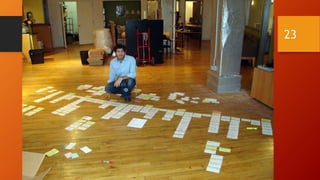

Story Maps: User Stories + Release Planning
22
ReleasePlanning
Usage
Sequence
Activities/
Backbone
S
T
O
R
I
E
S
23

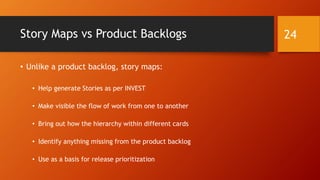

Story Maps vs Product Backlogs
• Unlike a product backlog, story maps:
• Help generate Stories as per INVEST
• Make visible the flow of work from one to another
• Bring out how the hierarchy within different cards
• Identify anything missing from the product backlog
• Use as a basis for release prioritization
24

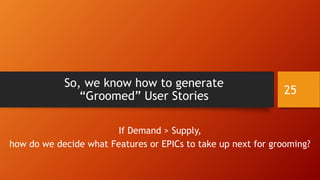

So, we know how to generate
“Groomed” User Stories
If Demand > Supply,
how do we decide what Features or EPICs to take up next for grooming?
25

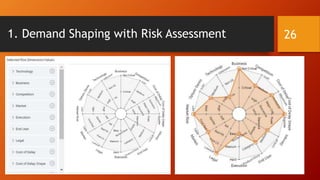

1. Demand Shaping with Risk Assessment 26
2. Improve Agility by knowing what to start!
Are we working on the right thing “now”?
Should we work on something else “now”?
27
Asking the right question…
From
“When can I get it?”
To
“When do you need it”
28
Once you know when do you need it…
Static Alerts
• Tools can track Due Dates -
have the Board highlight it
Dynamic predictions!
• Get the Forecast Completion Date
• If this is later than the Due Date, then
highlight the RISK on the Board
29
Due Date
19-Feb-2019
Due Date
Forecast
Date

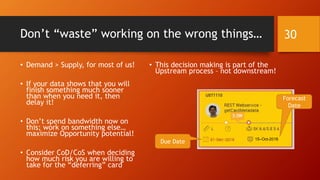

Don’t “waste” working on the wrong things…
• Demand > Supply, for most of us!
• If your data shows that you will
finish something much sooner
than when you need it, then
delay it!
• Don’t spend bandwidth now on
this; work on something else…
maximize Opportunity potential!
• Consider CoD/CoS when deciding
how much risk you are willing to
take for the “deferring” card
• This decision making is part of the
Upstream process – not downstream!
30
15–Oct-2018
Due Date
Forecast
Date

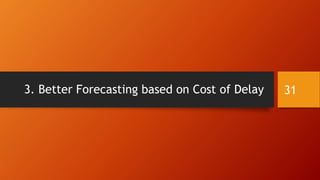

3. Better Forecasting based on Cost of Delay 31

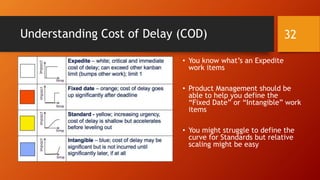

Understanding Cost of Delay (COD)
• You know what’s an Expedite
work items
• Product Management should be
able to help you define the
“Fixed Date” or “Intangible” work
items
• You might struggle to define the
curve for Standards but relative
scaling might be easy
32

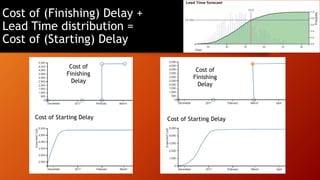

Cost of Starting Delay Cost of Starting Delay
Cost of
Finishing
Delay
Cost of
Finishing
Delay
Cost of (Finishing) Delay +
Lead Time distribution =
Cost of (Starting) Delay

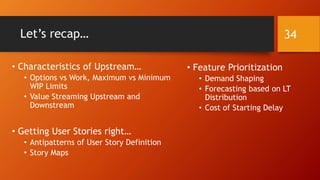

Let’s recap…
• Characteristics of Upstream…
• Options vs Work, Maximum vs Minimum
WIP Limits
• Value Streaming Upstream and
Downstream
• Getting User Stories right…
• Antipatterns of User Story Definition
• Story Maps
• Feature Prioritization
• Demand Shaping
• Forecasting based on LT
Distribution
• Cost of Starting Delay
34
• Reach me at:
• @sudiptal
• slahiri@digite.com
• lahiri.sudipta@gmail.com
THANK
YOU!
35
“Absorb what is useful, discard
what is useless and add what is
specifically your own”
Bruce Lee

Upstream: Shifting-left towards organization agility

  • 1.
  • 2.
    Upstream Shifting-Left towards OrganizationAgility Sudipta Lahiri Head of Engineering, Digite 2
  • 3.
    About Digité • Pioneerin Web-based Collaborative Products/ Solutions for Geographically Distributed Teams • Headquartered in Cupertino, CA • Products that cover Lean/ Kanban, Agile ALM, Project/ Portfolio Management 3
  • 4.
    About myself • Headof Engineering and Products @ Digité • Passionate about Lean-Agile • Speaker, Conference and Meetup Organizer 4 Sudipta Lahiri (Sudi)
  • 5.
  • 6.
  • 7.
    Setting the context… •The 1st Agile Principle: Our highest priority is to satisfy the customer through early and continuous delivery of valuable software. • What would be a single KPI if you want to focus on this priority? • Lead time (LT): From the time when the customer gave you some idea of what he/she wanted, how long did it take him/her to get it? • Keeping focus on LT helps all teams come together to serve a common objective: customer/user 7
  • 8.
    How do webring LT down? Ideation to Groomed Stories (including the front end) Specification to Dev Complete Dev Complete to Production Deployment Agile methods focus here DevOps extends the spectrum 8 This is well researched and we largely know what to do! Challenge is in adoption across the levels of the organization This is largely fuzzy… largely ignored and often, takes the bulk of LT Our focus today! DownstreamUpstream
  • 9.
    Upstream: Shifting AgilityLeft Ideation to Groomed Stories (including the front end) Specification to Dev Complete Dev Complete to Production Deployment 9 DownstreamUpstream WorkOptions Commitment Point Discards AbortsMinimum Maximum Towards Increasing Agility!
  • 10.
    Value Streaming Upstreamand Downstream Getting the right set of “groomed” stories 10
  • 11.
  • 12.
  • 13.
  • 14.
    Grooming “User Story”right… User Story != User Requirements 14
  • 15.
  • 16.
    16 If you goto a restaurant and see this: “Entree comes with soup or salad and bread” What would you interpret? (Soup or Salad) and Bread OR Soup or (Salad and Bread)?
  • 17.
  • 18.
  • 19.
    What’s the mostcommon reaction to this? 19
  • 20.
    Root cause issomewhere else: Nature of applications have changed! Back then… Now… 20
  • 21.
    Common User Story“anti-patterns” • User Stories != User Requirements • A basis of conversation! • Do not follow the INVEST criteria • Small, independent, Testable • Ambiguous language in User Stories • Tasks wrapped as User Stories • No clear Acceptance Criteria • All business rules != Acceptance Criteria • Consider BDD • Agile welcomes changing requirement • You still need to give as much clarity that you have today! • Horizontal work items (vs) verticals slices of functionality • Estimation is classic waste; minimize it! 21 Badly Groomed User Stories will impede Organization’s Agility!
  • 22.
    Story Maps: UserStories + Release Planning 22 ReleasePlanning Usage Sequence Activities/ Backbone S T O R I E S
  • 23.
  • 24.
    Story Maps vsProduct Backlogs • Unlike a product backlog, story maps: • Help generate Stories as per INVEST • Make visible the flow of work from one to another • Bring out how the hierarchy within different cards • Identify anything missing from the product backlog • Use as a basis for release prioritization 24
  • 25.
    So, we knowhow to generate “Groomed” User Stories If Demand > Supply, how do we decide what Features or EPICs to take up next for grooming? 25
  • 26.
    1. Demand Shapingwith Risk Assessment 26
  • 27.
    2. Improve Agilityby knowing what to start! Are we working on the right thing “now”? Should we work on something else “now”? 27
  • 28.

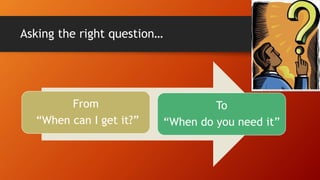

    Asking the rightquestion… From “When can I get it?” To “When do you need it” 28
