Driving Large Scale Agile
Transformation
Svante Lidman
svante@ivarjacobson.com   I have changed employer since
                          I made this presentation. You
                          can now reach me at
                          svante.lidman@hansoft.se,
                          see: www.hansoft.se for what
                          we do.
This presentation

• Patterns and anti-patterns for transforming an organization with
  huge legacy in product, process, and culture to being lean/agile
• Based on:
    – Experience in the large over the last 18 months
    – Experience in the not quite so large over the
      previous 25 years
    – Hearsay, reading
    – Thinking, trying to generalize, evolve, reformulate
• It is the story as I see it, others may have other
  stories

Outline

•   Introduction
•   What’s the deal with large scale agile?
•   Case study
•   Conclusions and advice
What’s the challenge with large scale agile?

• Given a large organization, potentially distributed,
  potentially large legacy in product and culture,
  what do we need to focus on?
• Practices?
• Organization?
• Tooling?

Individuals and interactions over processes and tools
What’s software development after all?

• Software development
   – A cooperative, Finite, Goal-Seeking Group Game (Alistair Cockburn)
   – I would add creative and evolving (Svante)
• Software is intellectual property, hence…
   – Developing software is an intellectual achievement, hence...
   – ... to create an effective SW development organization it is key to:
       • Maximimize the extent that everyone’s intellect is engaged and aligned
       • Eliminate disturbances that disallows people from being fully effective
         intellectually
Outline

•   Introduction
•   What’s the deal with large scale agile?
•   Case study
•   Conclusions and advice
The case in question

• Product development unit in a large multi-national company:
    – Thousands of developers
    – Single product line
    – Large legacy system
    – Distributed, component-based organization - waterfall process
    – Highly successful commercially and of fundamental importance to the
      bottom-line of the company
    – Fierce market competition
• If it ain’t broken why fix it?
Pain – a prerequisite for change

• Pain
   – Increasingly difficult to get even small features
     developed with reasonable lead times
   – Quality through sweat and tears
   – Development capacity not matching the business
     opportunities
• We want to do more!
Cause of pain

• Functional organization
    –   Analysis
    –   Software development
    –   System testing
    –   Waterfall process and an organization that defines
        itself in those terms
• Handovers and functional/component breakdown
    – Few persons understand the whole product
    – Few persons understands the whole process
• Focus on resource utilization by upfront planning          Fredrick Winslow Taylor

Insight: We can’t patch on the waterfall anymore
and get what we want, we need to do something
different
Building the vision for lean / agile

• Stories that people can
  relate to
• A simple message
The Vision Summarized

• Change to a setup where feature development is
  driven in a program decoupled from release projects.
  This is called Streamline Development.
• Implement true cross-functional feature teams with
  responsibility for a feature from analysis through end
  of feature verification
• Enable agility on the team level (Self-organization,
  Stand-ups, Iterations, Retrospectives, TDD,
  Continuous
  Integration and so on)
Key Ideas of the vision

• Focus on flow, customer-to-customer
    – It is more interesting to reduce lead-time with constant productivity
      than to improve productivity with constant lead-time
    – It is more interesting to improve quality with constant productivity than
      to increase productivity with constant quality
• This will expose inefficiencies and force:
    – Reduction of handovers
    – Reduction of delays
    – Reduction of overly detailed studies
      and gold-plated designs
    – Eradication of late and non-repeatable testing
      as a way to get quality

• The focus on lead-time will act as a forcing function
  to address quality and efficiency
Objections to the vision

• We have special needs
   – It is a very large code base, a single designer cannot learn all
   – Some subsystems are complex and requires substantial experience
   – Many different technologies, it is too difficult to learn them all
   – Some features are very large and span the whole system a single
     team cannot handle such a feature
   – Weak code ownership will deteriorate the integrity of the code base
   – It is a complicated domain, experts need to do analysis and design
• That stuff doesn’t work
   – We tried that 7 years ago and it didn’t work
   – Organization X tried that 4 years ago and they dropped it
Pilot – first strike

• We wanted select a pilot with the following characteristics:
    – Right size for a team of 5-7 to complete in 3-4 months
    – Relatively isolated not too much dependencies
    – It should have business value but not be too important
• And we failed before the start line!
Pilot – second strike

• Feature that we already looked at:
    – Too large
    – Too complicated
    – Too important – essential for release
      of new high-end product
    – Work already ongoing
• Waterfall planning now showed that
  this feature would delay the new
  product with 2-3 months
• Hastily we formed a cross functional team that:
    – Sat together (as far as possible)
    – Worked iteratively and light-weight
    – Delivered the feature in a way that did not risk the schedule of the
      new product (took us 7 months)
    – About same cost as projected for traditional way of work
This was the right pilot at the right time

• It had very high business impact and
  high risk -> Attention!
• At sprint reviews/demos we could review:
   – Logic behind our iterative plan
   – Challenges / Issues / Impediments
       • Low quality on the main/trunk forcing us to
         stay on branch using old baselines
       • The difficulty in defining good back log items
       • Problems with IT infrastructure
       • Culture and practices enforcing waterfall behavior
       • Challenges in existing within the big waterfall
       • Shortcomings in tooling / automation
       • Challenges in getting a team assigned, allocated and seated
• Management put a lot of trust in the team!
Advice on pilots

• Don’t run pilots to:
    – Prove that things “work”
    – Benchmark against current ways-of-working
• Do run pilots to:
    – Learn
    – Find problems that you need to fix
• The ideal pilot is:
    – Critical to business
    – Delayed
    – Quite large
• Organizational impediments will surface and become hot issues
  immediately
• Management will care and chances are you will get focus on
  solving some real problems
Find a role model

• Find an organization quite like your own – we got lucky!
    –   Based on the same platform, using same tools
    –   Similarities in culture
    –   Similar order of magnitude of the code base
    –   Very similar starting position in terms of pains,
        processes, organization and culture
• This organization had made a radical change:
    –   Streamline on the high level
    –   Scrum on the team level
    –   Large scale continuous integration
    –   Massive cultural change
It takes an engine to go the distance

• Someone from top management needs to step up
• Ideal characteristics
   –   Highly trusted inside and outside
   –   Eager to learn
   –   Courageous
   –   Inclusive

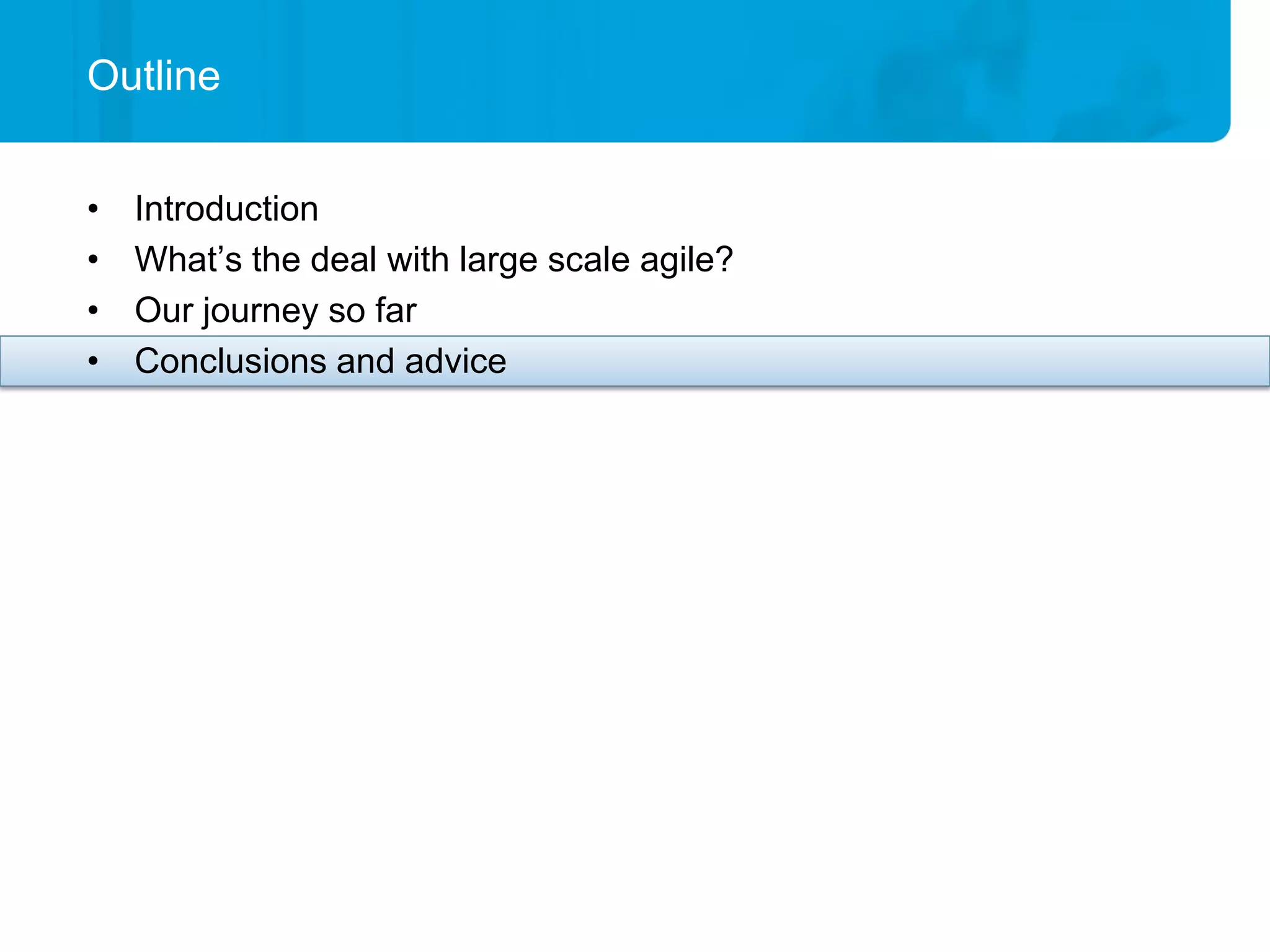

Outline

•   Introduction
•   What’s the deal with large scale agile?
•   Our journey so far
•   Conclusions and advice
Keep your eye on the ball

• Ideas
   – Continuos improvement
   – Respect for people
• Practices
   –   Cross functional teams sitting together
   –   Working software every 2-4 weeks
   –   Visual management
   –   Go see
Question old truths

• Development should always be done in
  projects
• High resource utilization = effectiveness
• You should write the code ”once”
• Quality comes in a sequence of steps –
  developers develop the product, testers test it
• You get what you predict so we need detailed
  estimates based on detailed specifications
• To be professional you should cleanly separate
  the business side from the IT side
Beware of...

• Analysis-paralysis
• Tool mongers and method
  gnomes
• Leaders getting detached
• Throwing out your gems
• Parrots
• Masquerading
Advice for line managers

•   Educate yourself
•   Manage, lead, or teach?
•   You cannot delegate this agile / lean ”business”
•   What is it that really matters?
     – People
     – Values and principles
     – Practical help to remove impediments / accidental
       complexity
     – Way of working
• Essentially, line management is a support function, it is not part of
  the product development flow
Thank You!
Svante Lidman
svante@ivarjacobson.com   I have changed employer since
                          I made this presentation. You
                          can now reach me at
                          svante.lidman@hansoft.se,
                          see: www.hansoft.se for what
                          we do.
