Background
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
Disclaimer
This is a case study of what we did when selecting a WFP
analytics solution
A lot was learned the hard way; it worked for us and I believe
there are parts that could work for your company
Look for learnings called out in Red and Black boxes at
bottom of slides (first time I have tried this – hope it helps)
Samples provided to illustrate what we did and tools are
included to make the process easier
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics

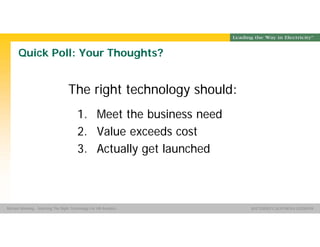

Quick Poll: Your Thoughts?
The right technology should:
1. Meet the business need
2. Value exceeds cost
3. Actually get launched
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics

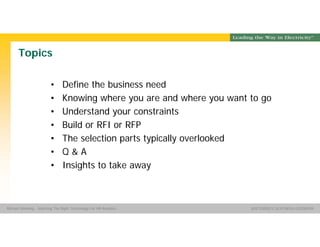

Topics
• Define the business need
• Knowing where you are and where you want to go
• Understand your constraints
• Build or RFI or RFP
• The selection parts typically overlooked
• Q & A
• Insights to take away
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
Define the Business Need
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
Timeline&MajorSteps
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
Define the Business Need
It all starts with Business Need
• Business needs the ability to: [Insert your needs here]
Our Sample
from workforce planning
ACTION – Clearly capture business needs and use them in your statement of
work…and in your communication plan
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
ACTION – Get stakeholders involved upfront in requirements and if possible
vendor selection and/or build blueprinting
Knowing where you are and where you want to go
Questions to consider
• What your stakeholders need from an analytics solution now
• What they will need in the future
INSIGHT – Change management starts prior to buy or build decision
For us this involved
• going out and having conversations with ~50 stakeholders
• documenting the results
• confirming ‘wants’ back with the stakeholders
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
Knowing where you are and where you want to go

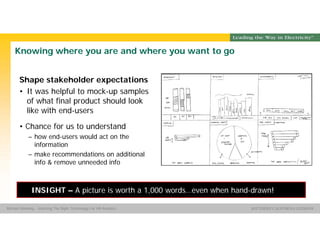

Shape stakeholder expectations
• It was helpful to mock-up samples
of what final product should look
like with end-users
• Chance for us to understand
– how end-users would act on the
information
– make recommendations on additional
info & remove unneeded info
INSIGHT – A picture is worth a 1,000 words…even when hand-drawn!
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
Knowing where you are and where you want to go
Questions to consider:
1. What measures will the technology deliver?
2. Do you have data definitions in place? (Question for later - can a vendor accommodate
your definitions?)
3. What is the frequency you will be delivering (daily, weekly, monthly)
4. Do you need drill-through to get to the underlying data or is chart/graph sufficient?
INSIGHT – Defined measures and drill through can change the conversation
from data quality to what the data means
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics

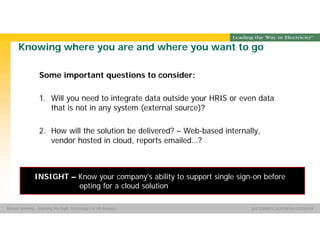

Knowing where you are and where you want to go
Some important questions to consider:
1. Will you need to integrate data outside your HRIS or even data
that is not in any system (external source)?
2. How will the solution be delivered? – Web-based internally,
vendor hosted in cloud, reports emailed…?
INSIGHT – Know your company's ability to support single sign-on before
opting for a cloud solution
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
Knowing where you are and where you want to go
Some important questions to consider
1. Will you be bringing in external benchmarking data for comparison to
your data?
2. What will user security need to be? Can everyone see everything – their
area and the rest of company – or just their area?
3. How will user access be maintained when people change roles or leave
the company?
INSIGHT – Enabling benchmark comparisons of a division to the whole
company to external companies is very valuable
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
Knowing where you are and where you want to go

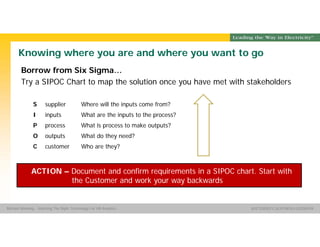

Borrow from Six Sigma…
Try a SIPOC Chart to map the solution once you have met with stakeholders
S supplier Where will the inputs come from?
I inputs What are the inputs to the process?
P process What is process to make outputs?
O outputs What do they need?
C customer Who are they?
ACTION – Document and confirm requirements in a SIPOC chart. Start with
the Customer and work your way backwards
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics

Knowing where you are and where you want to go
Our sample
SIPOC
INSIGHT – Leverage 6 sigma tools - SIPOC chart can be used in Statement
of Work
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
Knowing where you are and where you want to go
Some of the pieces in our Statement Of Work (SOW)
• Business need
• Solution requirements
• Security
• Availability of solution
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
Avoid Internal Roadblocks
• Gain agreement on the steps in the
buy or build process
• Involve folks who will be supporting
the process – get their agreement on
the path forward
Our sample
Selection and purchasing
Process:
INSIGHT – A clear and agreed upon
selection process makes passive resistance
more difficult (that’s a good thing)
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
• List the process steps from
selection and purchasing process
here
• Assign RACI to each team
member
Teammember1
Teammember2
Teammember3
Teammember4
Teammember5
Teammember6
Teammember7
Teammember8
Teammember9
1 Confirm money in budget to be spent in 2010 C A/R I I
2
CCI build not viable due to time restrictions or
functionality requirements I C C I I I
3 TRM grants approval to purchase externally I C C I I A/R C C
4 Gate 2 approval I I A/R I I R
5 Contact vendors and schedule meeting I I A/R I I I I I I
6
Send Vendors pre meeting T&Cs, SOW, SIPOC and
other docs I C C A/R C C
7 Attend vendor review Oct 27 & 28 R A/R R R R ? R R
8 Vendor can provide required service I R A/R
9 Vendor is financially sound I I I A/R I
10 Vendor will accept our contract language I I I A/R C
11 Vendors offering will work in our IT environment I I I C A/R
12
Vendors offering complies with our security
requirements I I I C A/R
Responsible - Those who do work to achieve the task. There can be multiple resources
responsible.
Accountable - (Also Approver) The resource ultimately answerable for the
correct and thorough completion of the task.
Consulted - Those whose opinions are sought. Two-way communication.
Informed - Those who are kept up-to-date on progress. One-way communication.
R responsible
A accountable
C consulted
I informed
ACTION – Define who will be making what decisions ahead of time – it pulls
the politics out
Avoid Internal
Roadblocks
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics

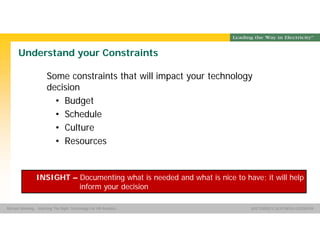

Understand your Constraints
Some constraints that will impact your technology
decision
• Budget
• Schedule
• Culture
• Resources
INSIGHT – Documenting what is needed and what is nice to have; it will help
inform your decision
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics

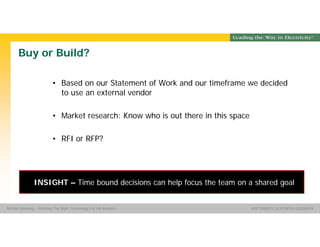

Buy or Build?
• Based on our Statement of Work and our timeframe we decided
to use an external vendor
• Market research: Know who is out there in this space
• RFI or RFP?
INSIGHT – Time bound decisions can help focus the team on a shared goal
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
Important IT Considerations
• Know your company’s cybersecurity requirements (may determine
whether or not you can use an outside provider)
• Know how your data will be transferred back and forth from the vendor,
how it will be stored and backed up, location of backup facilities, and
encryption requirements
• Know your IT department’s availability and capability to implement and
support the solution
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics

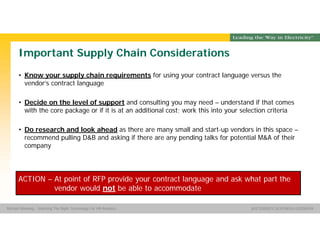

Important Supply Chain Considerations
• Know your supply chain requirements for using your contract language versus the
vendor’s contract language
• Decide on the level of support and consulting you may need – understand if that comes
with the core package or if it is at an additional cost; work this into your selection criteria
• Do research and look ahead as there are many small and start-up vendors in this space –
recommend pulling D&B and asking if there are any pending talks for potential M&A of their
company
ACTION – At point of RFP provide your contract language and ask what part the
vendor would not be able to accommodate
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics

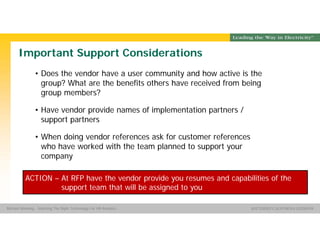

Important Support Considerations
• Does the vendor have a user community and how active is the
group? What are the benefits others have received from being
group members?
• Have vendor provide names of implementation partners /
support partners
• When doing vendor references ask for customer references
who have worked with the team planned to support your
company
ACTION – At RFP have the vendor provide you resumes and capabilities of the
support team that will be assigned to you
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
A final demo based on the vendor RFP response
• We brought back our top 3 vendors to show us how their solutions would
meet our Statement of Work
• Had the same planned scenarios for each of the 3 finalist vendors to
demonstrate
• Involved stakeholders and IT in the vendor demos
ACTION – Include time ½ way through each demo to send the vendor out of
the room and discuss what they presented; identify unanswered
and new questions to ask when the vendor is back in the room
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics

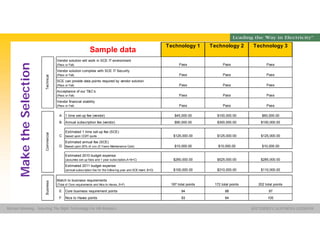

Sample data
Technology 1 Technology 2 Technology 3
Pass Pass Pass
Pass Pass Pass
Pass Pass Pass
Pass Pass Pass
Pass Pass Pass
A 1 time set-up fee (vendor) $45,000.00 $100,000.00 $60,000.00
B Annual subscription fee (vendor) $90,000.00 $300,000.00 $100,000.00
C
Estimated 1 time set-up fee (SCE)
based upon CCI/IT quote $125,000.00 $125,000.00 $125,000.00
D
Estimated annual fee (SCE)
Based upon 20% of xxx (5 Years Maintenance Cost) $10,000.00 $10,000.00 $10,000.00
Estimated 2010 budget expense
(assumes set-up fees and 1 year subscription,A+B+C) $260,000.00 $525,000.00 $285,000.00
Estimated 2011 budget expense
(annual subscription fee for the follow ing year and SCEmaint, B+D) $100,000.00 $310,000.00 $110,000.00
187 total points 172 total points 202 total points
E Core business requirement points 94 88 97
F Nice to Haves points 93 84 105
BusinessCommercialTechnical
Acceptance of our T&C’s
(Pass or Fail)
Match to business requirements
(Total of Core requirements and Nice to Haves, E+F)
Vendor solution will work in SCE IT environment
(Pass or Fail)
Vendor solution complies with SCE IT Security
(Pass or Fail)
SCE can provide data points required by vendor solution
(Pass or Fail)
Vendor financial stability
(Pass or Fail)
MaketheSelection
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
Q & A
Group Name SOUTHERN CALIFORNIA EDISON
SMSM
SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics
Knowing where you are and where you want to go

Selecting The Right Technology For HR Analytics San Diego Deck

  • 1.
    Presentation Title SOUTHERNCALIFORNIA EDISON® SM SOUTHERN CALIFORNIA EDISON® SM Selecting The Right Technology For HR Analytics Workforce and HR Analytics Summit West March 9, 2015 Presented by Michael L Manning Principal Manager, HR Shared Services Southern California Edison (626) 302-5232 Michael.L.Manning@SCE.com
  • 2.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON® Background
  • 3.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Disclaimer This is a case study of what we did when selecting a WFP analytics solution A lot was learned the hard way; it worked for us and I believe there are parts that could work for your company Look for learnings called out in Red and Black boxes at bottom of slides (first time I have tried this – hope it helps) Samples provided to illustrate what we did and tools are included to make the process easier
  • 4.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Quick Poll: Your Thoughts? The right technology should: 1. Meet the business need 2. Value exceeds cost 3. Actually get launched
  • 5.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Topics • Define the business need • Knowing where you are and where you want to go • Understand your constraints • Build or RFI or RFP • The selection parts typically overlooked • Q & A • Insights to take away
  • 6.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Define the Business Need
  • 7.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Timeline&MajorSteps
  • 8.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Define the Business Need It all starts with Business Need • Business needs the ability to: [Insert your needs here] Our Sample from workforce planning ACTION – Clearly capture business needs and use them in your statement of work…and in your communication plan
  • 9.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics ACTION – Get stakeholders involved upfront in requirements and if possible vendor selection and/or build blueprinting Knowing where you are and where you want to go Questions to consider • What your stakeholders need from an analytics solution now • What they will need in the future INSIGHT – Change management starts prior to buy or build decision For us this involved • going out and having conversations with ~50 stakeholders • documenting the results • confirming ‘wants’ back with the stakeholders
  • 10.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Knowing where you are and where you want to go Shape stakeholder expectations • It was helpful to mock-up samples of what final product should look like with end-users • Chance for us to understand – how end-users would act on the information – make recommendations on additional info & remove unneeded info INSIGHT – A picture is worth a 1,000 words…even when hand-drawn!
  • 11.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Knowing where you are and where you want to go Questions to consider: 1. What measures will the technology deliver? 2. Do you have data definitions in place? (Question for later - can a vendor accommodate your definitions?) 3. What is the frequency you will be delivering (daily, weekly, monthly) 4. Do you need drill-through to get to the underlying data or is chart/graph sufficient? INSIGHT – Defined measures and drill through can change the conversation from data quality to what the data means
  • 12.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Knowing where you are and where you want to go Some important questions to consider: 1. Will you need to integrate data outside your HRIS or even data that is not in any system (external source)? 2. How will the solution be delivered? – Web-based internally, vendor hosted in cloud, reports emailed…? INSIGHT – Know your company's ability to support single sign-on before opting for a cloud solution
  • 13.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Knowing where you are and where you want to go Some important questions to consider 1. Will you be bringing in external benchmarking data for comparison to your data? 2. What will user security need to be? Can everyone see everything – their area and the rest of company – or just their area? 3. How will user access be maintained when people change roles or leave the company? INSIGHT – Enabling benchmark comparisons of a division to the whole company to external companies is very valuable
  • 14.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Knowing where you are and where you want to go Borrow from Six Sigma… Try a SIPOC Chart to map the solution once you have met with stakeholders S supplier Where will the inputs come from? I inputs What are the inputs to the process? P process What is process to make outputs? O outputs What do they need? C customer Who are they? ACTION – Document and confirm requirements in a SIPOC chart. Start with the Customer and work your way backwards
  • 15.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Knowing where you are and where you want to go Our sample SIPOC INSIGHT – Leverage 6 sigma tools - SIPOC chart can be used in Statement of Work
  • 16.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Knowing where you are and where you want to go Some of the pieces in our Statement Of Work (SOW) • Business need • Solution requirements • Security • Availability of solution
  • 17.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Avoid Internal Roadblocks • Gain agreement on the steps in the buy or build process • Involve folks who will be supporting the process – get their agreement on the path forward Our sample Selection and purchasing Process: INSIGHT – A clear and agreed upon selection process makes passive resistance more difficult (that’s a good thing)
  • 18.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics • List the process steps from selection and purchasing process here • Assign RACI to each team member Teammember1 Teammember2 Teammember3 Teammember4 Teammember5 Teammember6 Teammember7 Teammember8 Teammember9 1 Confirm money in budget to be spent in 2010 C A/R I I 2 CCI build not viable due to time restrictions or functionality requirements I C C I I I 3 TRM grants approval to purchase externally I C C I I A/R C C 4 Gate 2 approval I I A/R I I R 5 Contact vendors and schedule meeting I I A/R I I I I I I 6 Send Vendors pre meeting T&Cs, SOW, SIPOC and other docs I C C A/R C C 7 Attend vendor review Oct 27 & 28 R A/R R R R ? R R 8 Vendor can provide required service I R A/R 9 Vendor is financially sound I I I A/R I 10 Vendor will accept our contract language I I I A/R C 11 Vendors offering will work in our IT environment I I I C A/R 12 Vendors offering complies with our security requirements I I I C A/R Responsible - Those who do work to achieve the task. There can be multiple resources responsible. Accountable - (Also Approver) The resource ultimately answerable for the correct and thorough completion of the task. Consulted - Those whose opinions are sought. Two-way communication. Informed - Those who are kept up-to-date on progress. One-way communication. R responsible A accountable C consulted I informed ACTION – Define who will be making what decisions ahead of time – it pulls the politics out Avoid Internal Roadblocks
  • 19.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Understand your Constraints Some constraints that will impact your technology decision • Budget • Schedule • Culture • Resources INSIGHT – Documenting what is needed and what is nice to have; it will help inform your decision
  • 20.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Buy or Build? • Based on our Statement of Work and our timeframe we decided to use an external vendor • Market research: Know who is out there in this space • RFI or RFP? INSIGHT – Time bound decisions can help focus the team on a shared goal
  • 21.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Important IT Considerations • Know your company’s cybersecurity requirements (may determine whether or not you can use an outside provider) • Know how your data will be transferred back and forth from the vendor, how it will be stored and backed up, location of backup facilities, and encryption requirements • Know your IT department’s availability and capability to implement and support the solution
  • 22.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Important Supply Chain Considerations • Know your supply chain requirements for using your contract language versus the vendor’s contract language • Decide on the level of support and consulting you may need – understand if that comes with the core package or if it is at an additional cost; work this into your selection criteria • Do research and look ahead as there are many small and start-up vendors in this space – recommend pulling D&B and asking if there are any pending talks for potential M&A of their company ACTION – At point of RFP provide your contract language and ask what part the vendor would not be able to accommodate
  • 23.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Important Support Considerations • Does the vendor have a user community and how active is the group? What are the benefits others have received from being group members? • Have vendor provide names of implementation partners / support partners • When doing vendor references ask for customer references who have worked with the team planned to support your company ACTION – At RFP have the vendor provide you resumes and capabilities of the support team that will be assigned to you
  • 24.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics A final demo based on the vendor RFP response • We brought back our top 3 vendors to show us how their solutions would meet our Statement of Work • Had the same planned scenarios for each of the 3 finalist vendors to demonstrate • Involved stakeholders and IT in the vendor demos ACTION – Include time ½ way through each demo to send the vendor out of the room and discuss what they presented; identify unanswered and new questions to ask when the vendor is back in the room
  • 25.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Sample data Technology 1 Technology 2 Technology 3 Pass Pass Pass Pass Pass Pass Pass Pass Pass Pass Pass Pass Pass Pass Pass A 1 time set-up fee (vendor) $45,000.00 $100,000.00 $60,000.00 B Annual subscription fee (vendor) $90,000.00 $300,000.00 $100,000.00 C Estimated 1 time set-up fee (SCE) based upon CCI/IT quote $125,000.00 $125,000.00 $125,000.00 D Estimated annual fee (SCE) Based upon 20% of xxx (5 Years Maintenance Cost) $10,000.00 $10,000.00 $10,000.00 Estimated 2010 budget expense (assumes set-up fees and 1 year subscription,A+B+C) $260,000.00 $525,000.00 $285,000.00 Estimated 2011 budget expense (annual subscription fee for the follow ing year and SCEmaint, B+D) $100,000.00 $310,000.00 $110,000.00 187 total points 172 total points 202 total points E Core business requirement points 94 88 97 F Nice to Haves points 93 84 105 BusinessCommercialTechnical Acceptance of our T&C’s (Pass or Fail) Match to business requirements (Total of Core requirements and Nice to Haves, E+F) Vendor solution will work in SCE IT environment (Pass or Fail) Vendor solution complies with SCE IT Security (Pass or Fail) SCE can provide data points required by vendor solution (Pass or Fail) Vendor financial stability (Pass or Fail) MaketheSelection
  • 26.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Q & A
  • 27.
    Group Name SOUTHERNCALIFORNIA EDISON SMSM SOUTHERN CALIFORNIA EDISON®Michael Manning - Selecting The Right Technology For HR Analytics Knowing where you are and where you want to go
