SlideShare a Scribd company logo
©Sabaruddinde AB
IT Management Series
© Ir. Sabaruddin de AB, M.AB
BAP – Managing Partner
Sabaruddin.deab@yahoo.com
0816554309
ERP Project Management
Successful in Managing ERP Implementation
1
©Sabaruddinde AB
Perlunya IT DepartemenFrom the Author

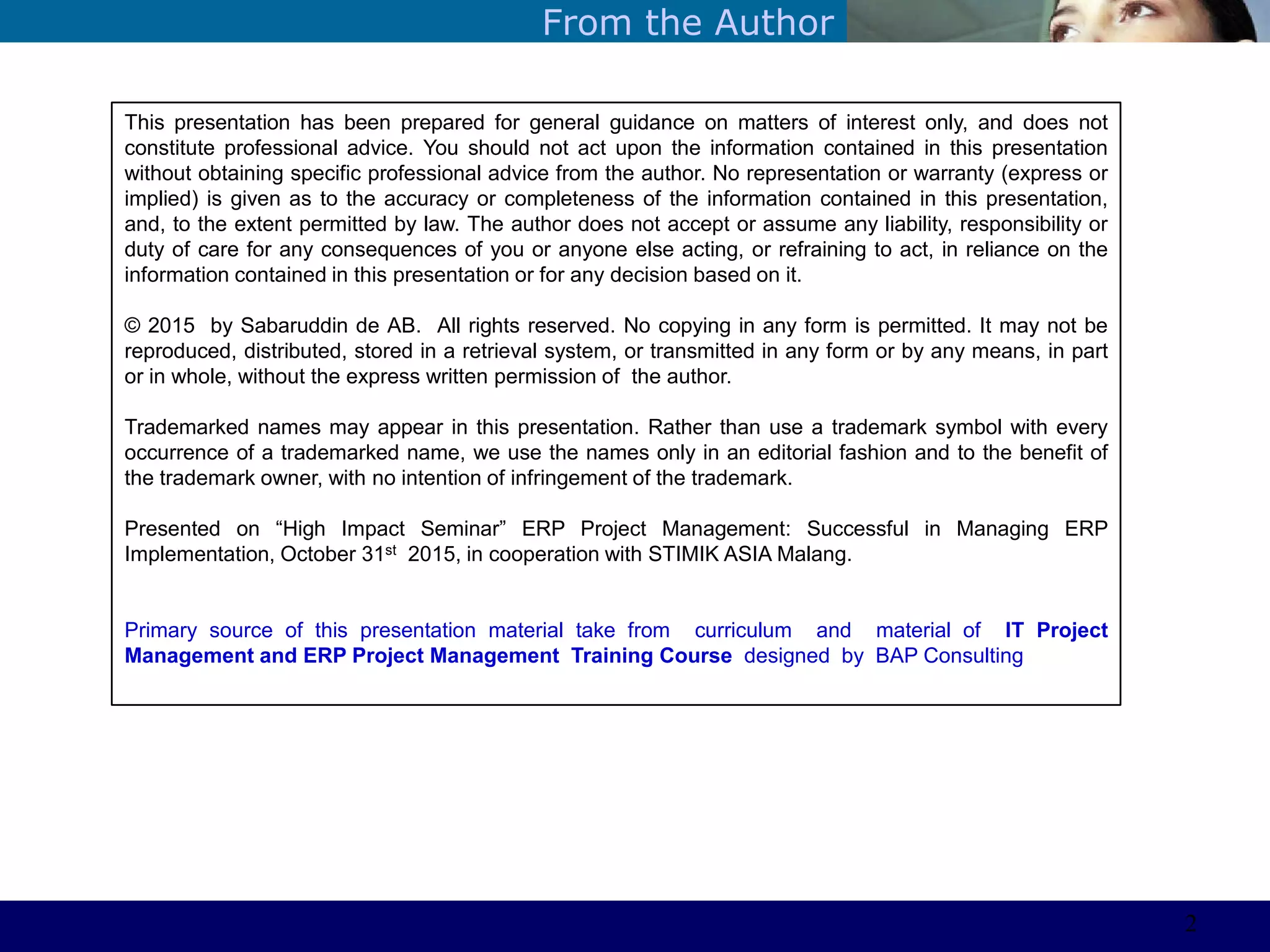

This presentation has been prepared for general guidance on matters of interest only, and does not
constitute professional advice. You should not act upon the information contained in this presentation
without obtaining specific professional advice from the author. No representation or warranty (express or
implied) is given as to the accuracy or completeness of the information contained in this presentation,
and, to the extent permitted by law. The author does not accept or assume any liability, responsibility or
duty of care for any consequences of you or anyone else acting, or refraining to act, in reliance on the
information contained in this presentation or for any decision based on it.
© 2015 by Sabaruddin de AB. All rights reserved. No copying in any form is permitted. It may not be
reproduced, distributed, stored in a retrieval system, or transmitted in any form or by any means, in part
or in whole, without the express written permission of the author.
Trademarked names may appear in this presentation. Rather than use a trademark symbol with every
occurrence of a trademarked name, we use the names only in an editorial fashion and to the benefit of
the trademark owner, with no intention of infringement of the trademark.
Presented on ―High Impact Seminar‖ ERP Project Management: Successful in Managing ERP
Implementation, October 31st 2015, in cooperation with STIMIK ASIA Malang.
Primary source of this presentation material take from curriculum and material of IT Project
Management and ERP Project Management Training Course designed by BAP Consulting
2
©Sabaruddinde AB
Perlunya IT Departemen
Objectives
Introduction
 To gain better approach in managing ERP Implementation
 To provide knowledge on effective ERP Project management to
conduct day to day Project Management Practices
 To provide participants with key soft-skills that are
important in ERP Project management Practices
3
©Sabaruddinde AB
Perlunya IT DepartemenIntroduction
ERP : What ?
ERP Vendor and Product :
Source : Internet (www)
4
©Sabaruddinde AB
Perlunya IT DepartemenIntroduction

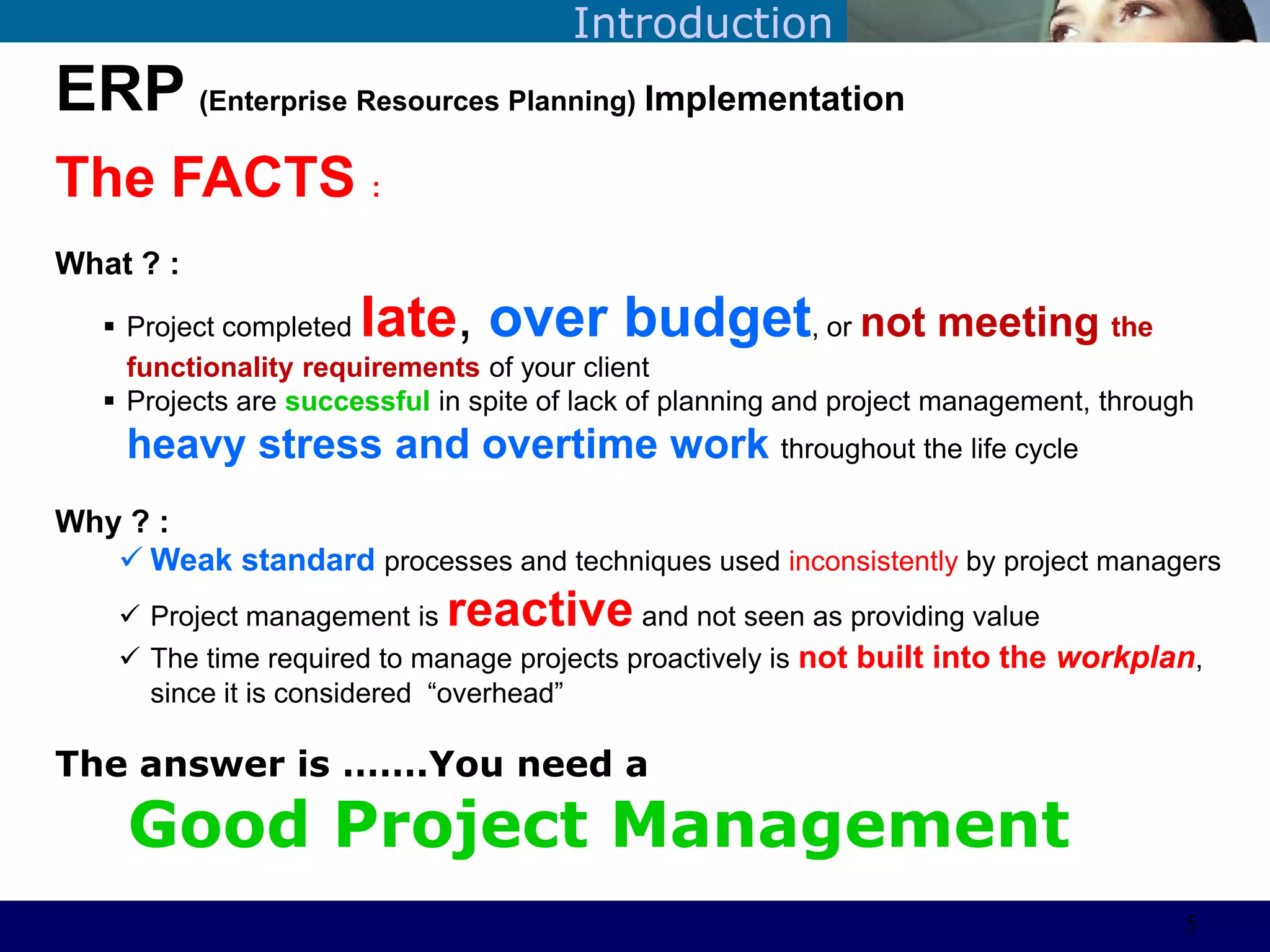

ERP (Enterprise Resources Planning) Implementation
The FACTS :
What ? :
 Project completed late, over budget, or not meeting the
functionality requirements of your client
 Projects are successful in spite of lack of planning and project management, through
heavy stress and overtime work throughout the life cycle
Why ? :
 Weak standard processes and techniques used inconsistently by project managers
 Project management is reactive and not seen as providing value
 The time required to manage projects proactively is not built into the workplan,
since it is considered ―overhead‖
The answer is …….You need a
Good Project Management
5
©Sabaruddinde AB
Perlunya IT DepartemenIntroduction

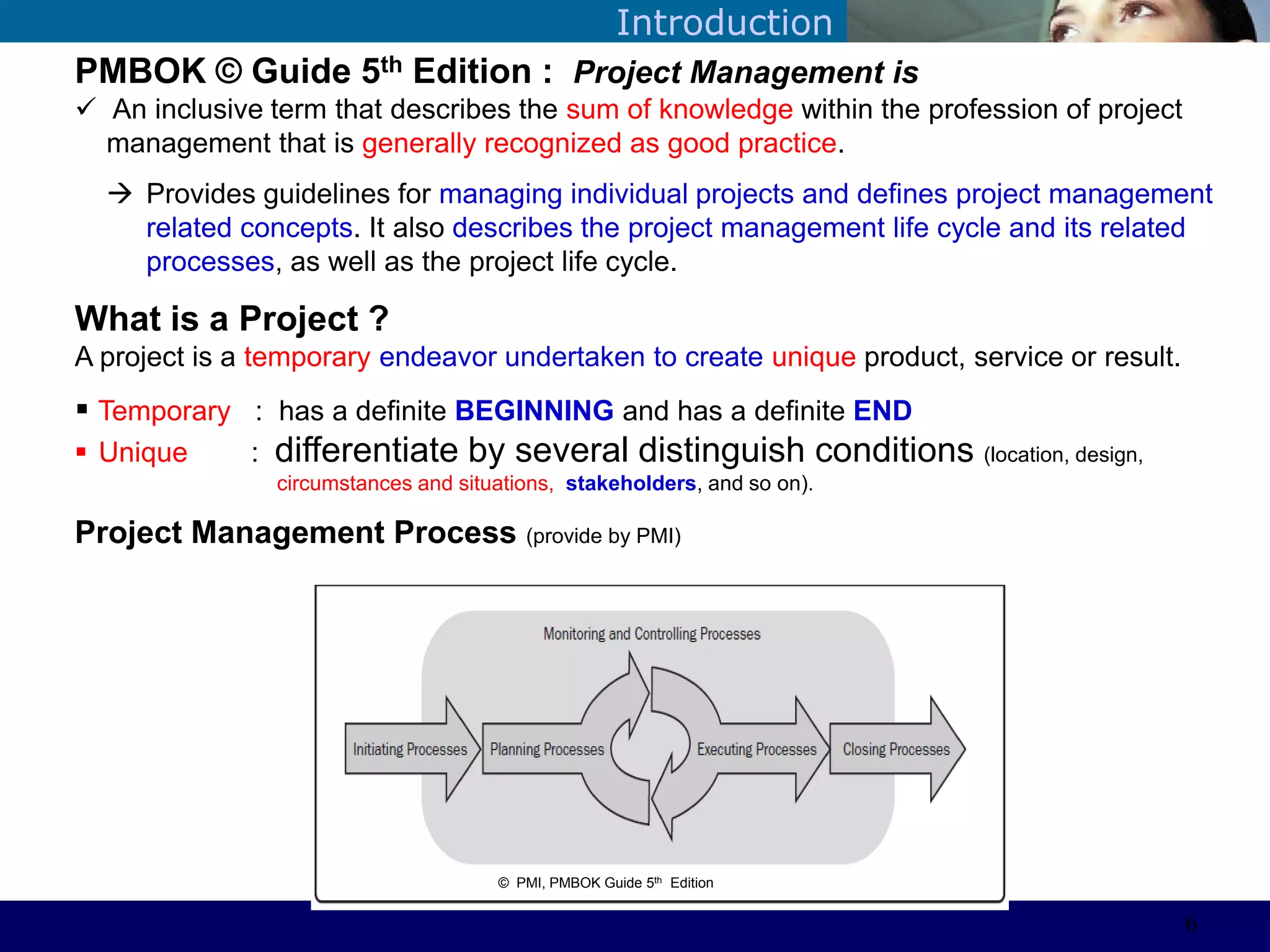

PMBOK © Guide 5th Edition : Project Management is
 An inclusive term that describes the sum of knowledge within the profession of project
management that is generally recognized as good practice.
 Provides guidelines for managing individual projects and defines project management
related concepts. It also describes the project management life cycle and its related
processes, as well as the project life cycle.
What is a Project ?
A project is a temporary endeavor undertaken to create unique product, service or result.
 Temporary : has a definite BEGINNING and has a definite END
 Unique : differentiate by several distinguish conditions (location, design,
circumstances and situations, stakeholders, and so on).
Project Management Process (provide by PMI)
© PMI, PMBOK Guide 5th Edition
6
©Sabaruddinde AB
Perlunya IT DepartemenWhy Business/Organization need ERP Implementation.

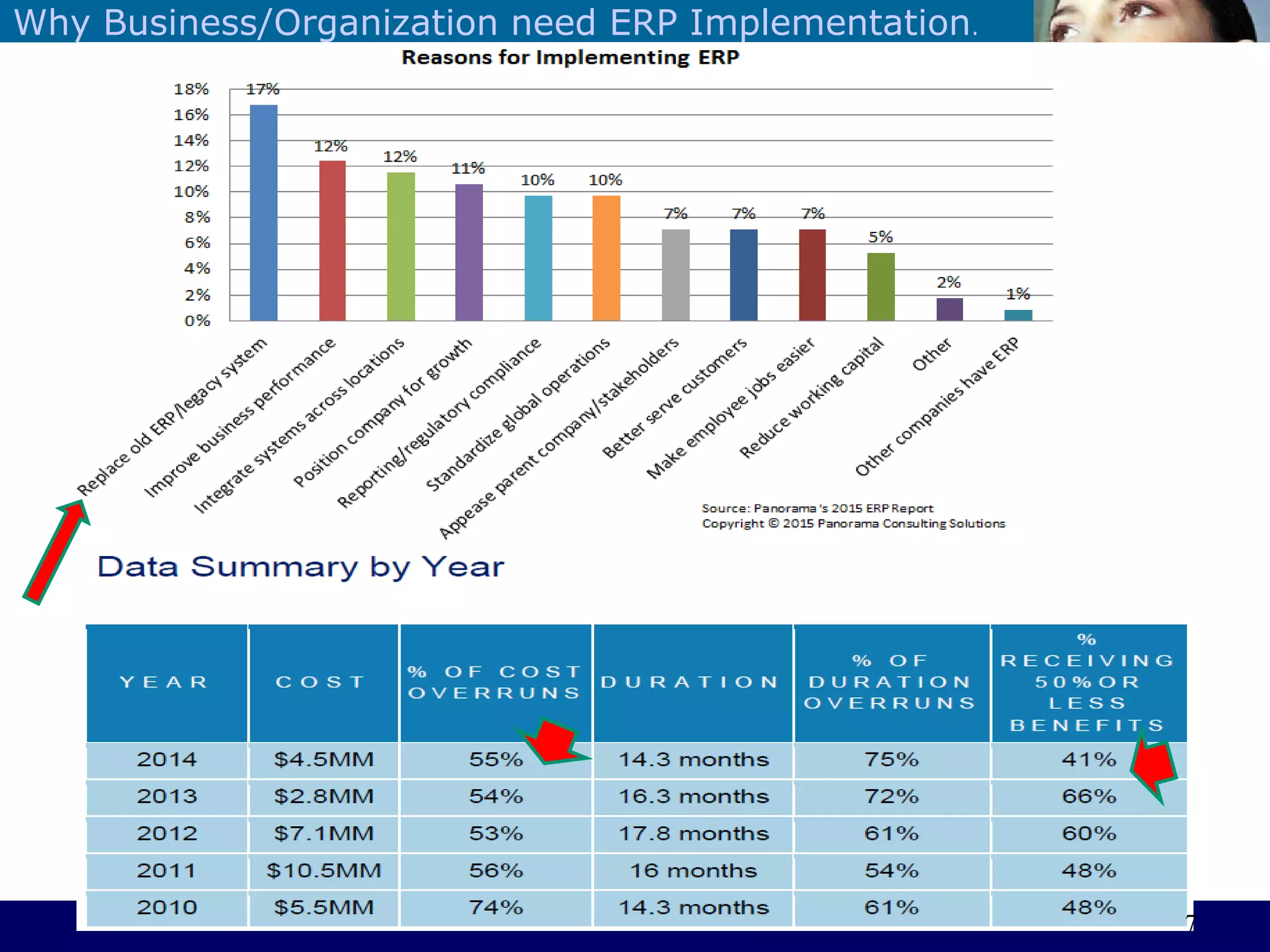

7
©Sabaruddinde AB
Perlunya IT DepartemenLearned from previous experiences (others company, survey, SME, etc)

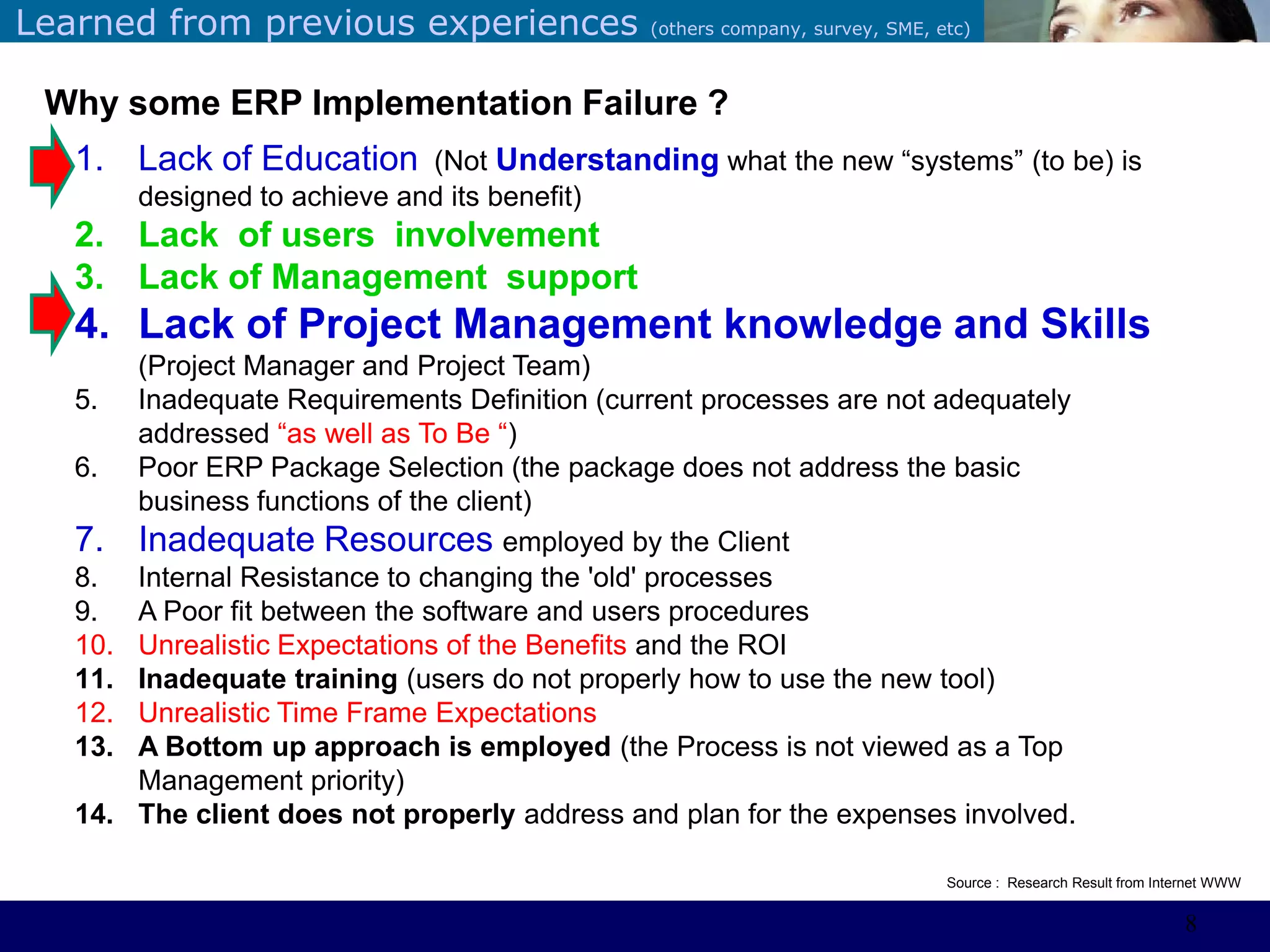

Why some ERP Implementation Failure ?
1. Lack of Education (Not Understanding what the new ―systems‖ (to be) is
designed to achieve and its benefit)
2. Lack of users involvement
3. Lack of Management support
4. Lack of Project Management knowledge and Skills
(Project Manager and Project Team)
5. Inadequate Requirements Definition (current processes are not adequately
addressed ―as well as To Be ―)
6. Poor ERP Package Selection (the package does not address the basic
business functions of the client)
7. Inadequate Resources employed by the Client
8. Internal Resistance to changing the 'old' processes
9. A Poor fit between the software and users procedures
10. Unrealistic Expectations of the Benefits and the ROI
11. Inadequate training (users do not properly how to use the new tool)
12. Unrealistic Time Frame Expectations
13. A Bottom up approach is employed (the Process is not viewed as a Top
Management priority)
14. The client does not properly address and plan for the expenses involved.
Source : Research Result from Internet WWW
8
©Sabaruddinde AB

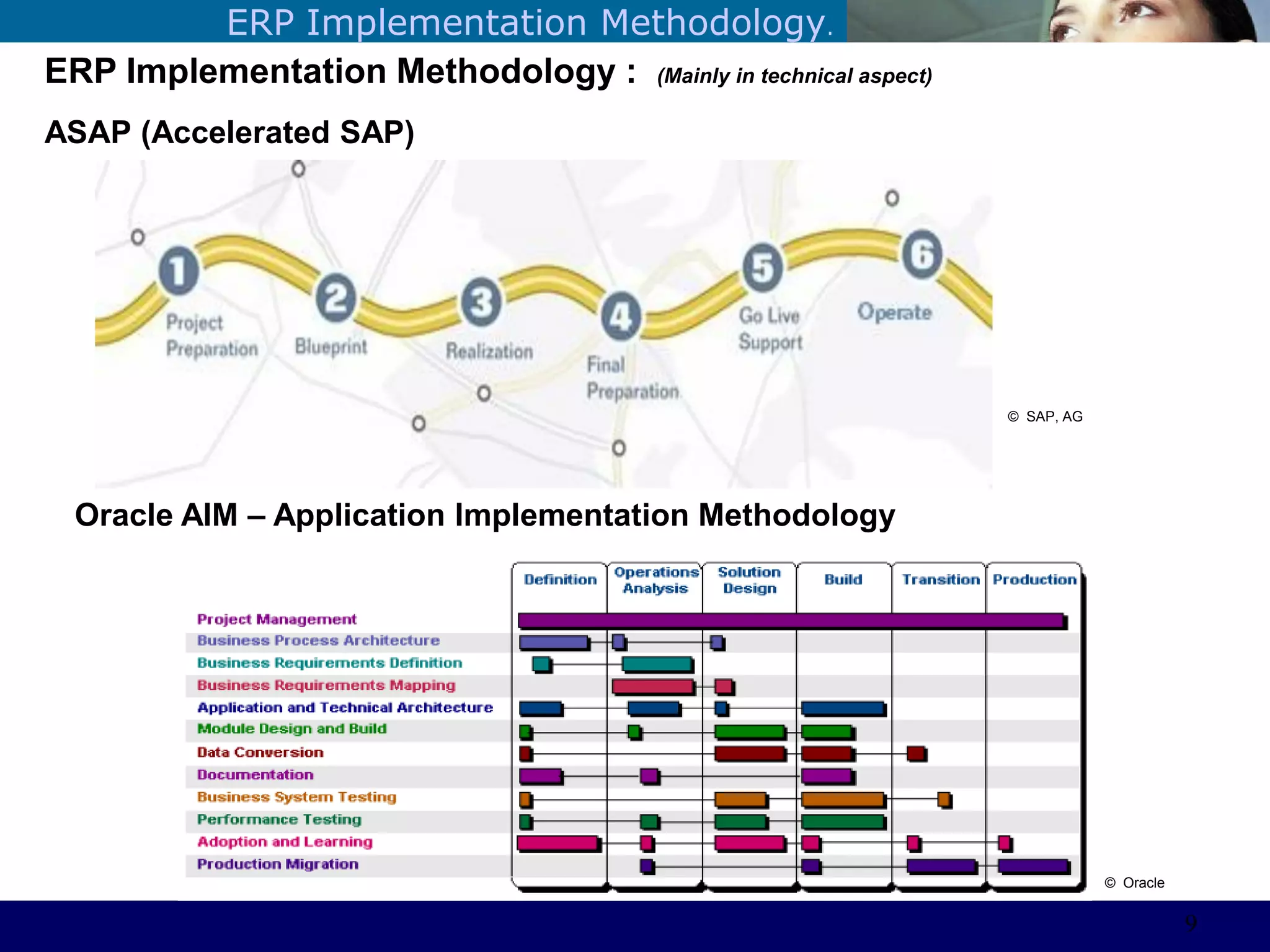

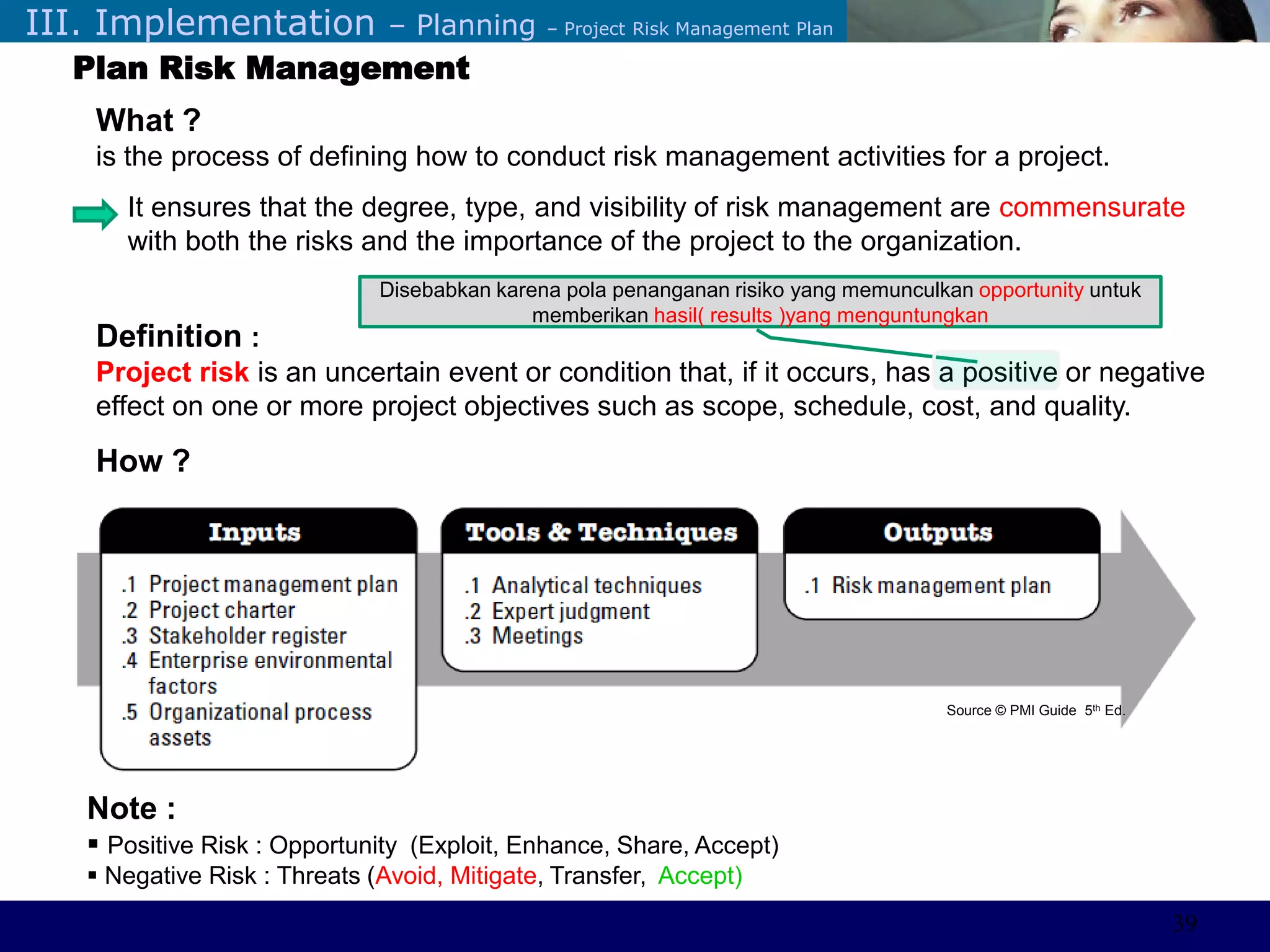

Perlunya IT DepartemenERP Implementation Methodology.
ERP Implementation Methodology : (Mainly in technical aspect)
ASAP (Accelerated SAP)
Oracle AIM – Application Implementation Methodology
© Oracle
© SAP, AG
9
©Sabaruddinde AB
Perlunya IT DepartemenERP Implementation - Strategy

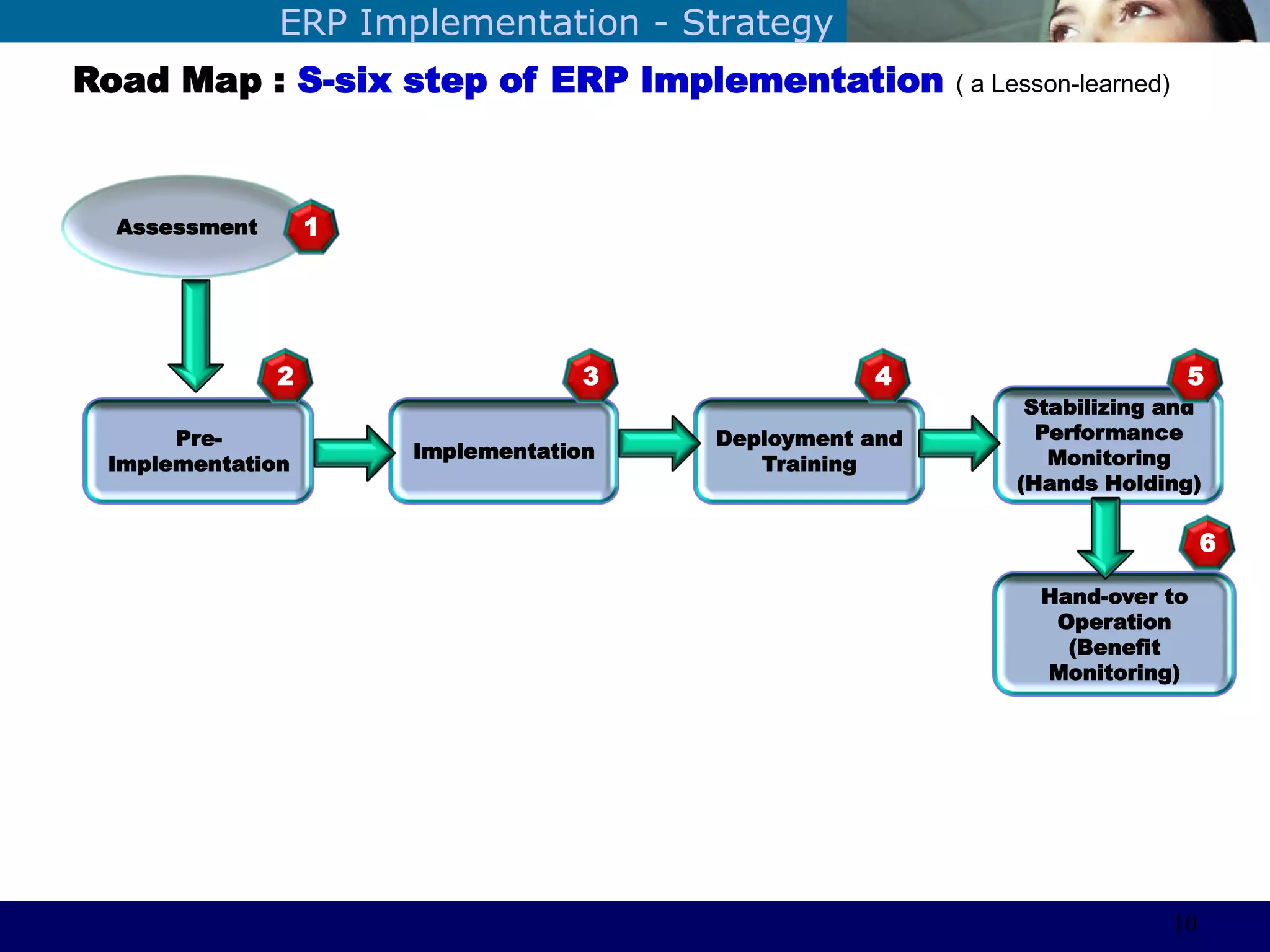

Road Map : S-six step of ERP Implementation ( a Lesson-learned)
Assessment
Pre-
Implementation
1
Implementation
Hand-over to
Operation
(Benefit
Monitoring)
Stabilizing and
Performance
Monitoring
(Hands Holding)
Deployment and
Training
5
6
432
10
©Sabaruddinde AB

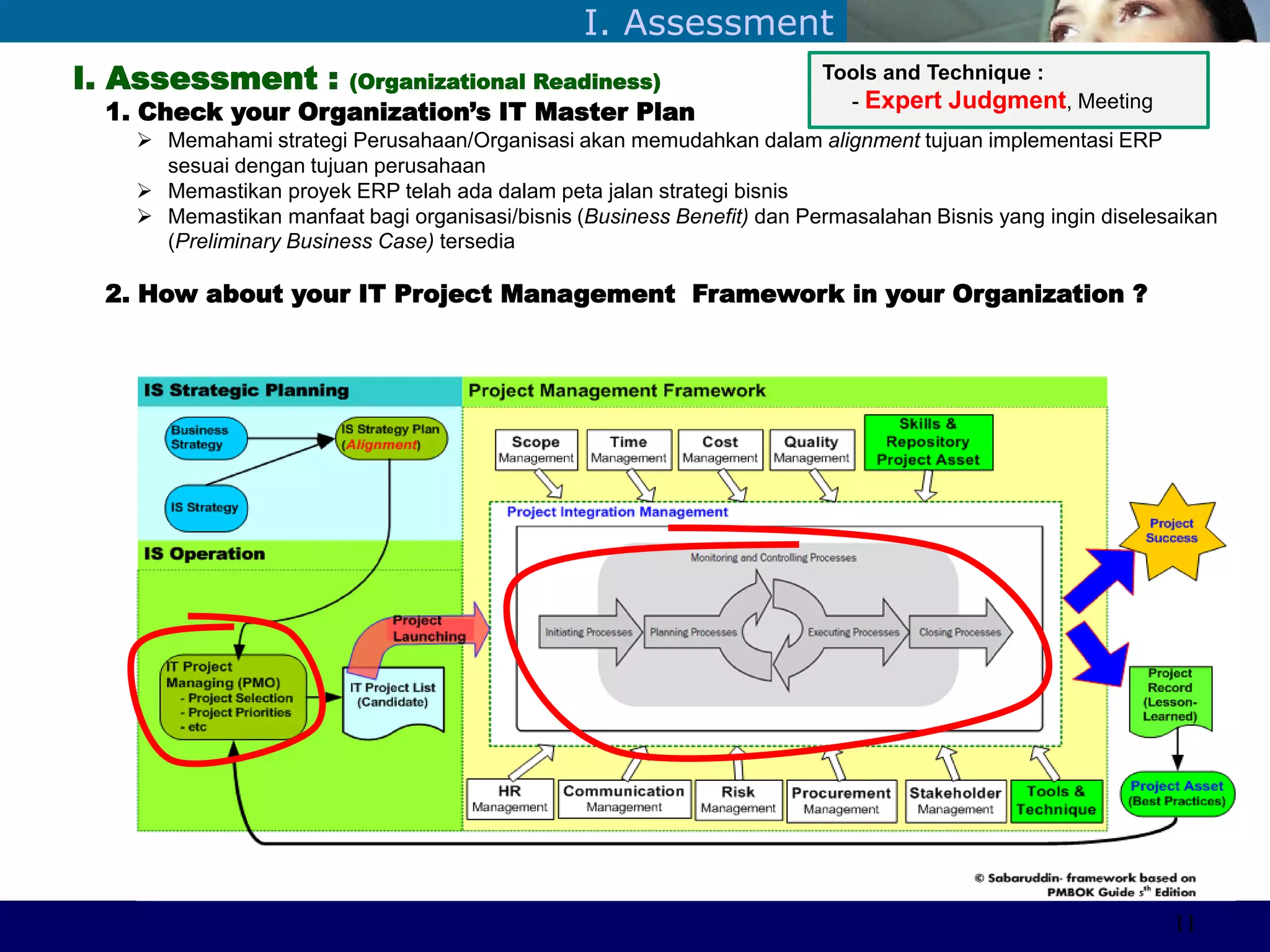

Perlunya IT DepartemenI. Assessment
I. Assessment : (Organizational Readiness)
1. Check your Organization’s IT Master Plan
 Memahami strategi Perusahaan/Organisasi akan memudahkan dalam alignment tujuan implementasi ERP
sesuai dengan tujuan perusahaan
 Memastikan proyek ERP telah ada dalam peta jalan strategi bisnis
 Memastikan manfaat bagi organisasi/bisnis (Business Benefit) dan Permasalahan Bisnis yang ingin diselesaikan
(Preliminary Business Case) tersedia
2. How about your IT Project Management Framework in your Organization ?
Tools and Technique :
- Expert Judgment, Meeting
11
©Sabaruddinde AB
Perlunya IT DepartemenI. Assessment

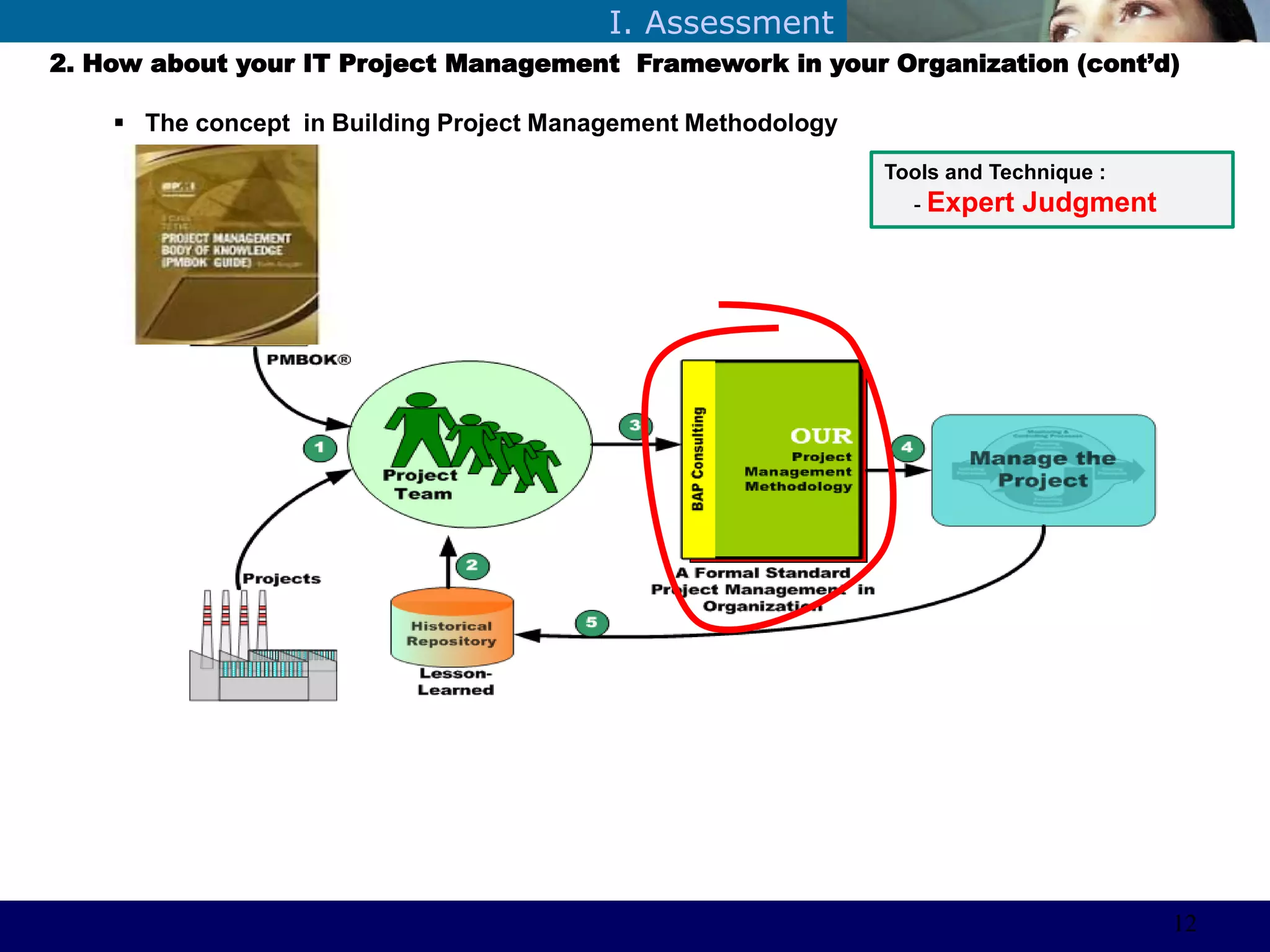

2. How about your IT Project Management Framework in your Organization (cont’d)
 The concept in Building Project Management Methodology
Tools and Technique :
- Expert Judgment
12
©Sabaruddinde AB
Perlunya IT DepartemenI. Assessment

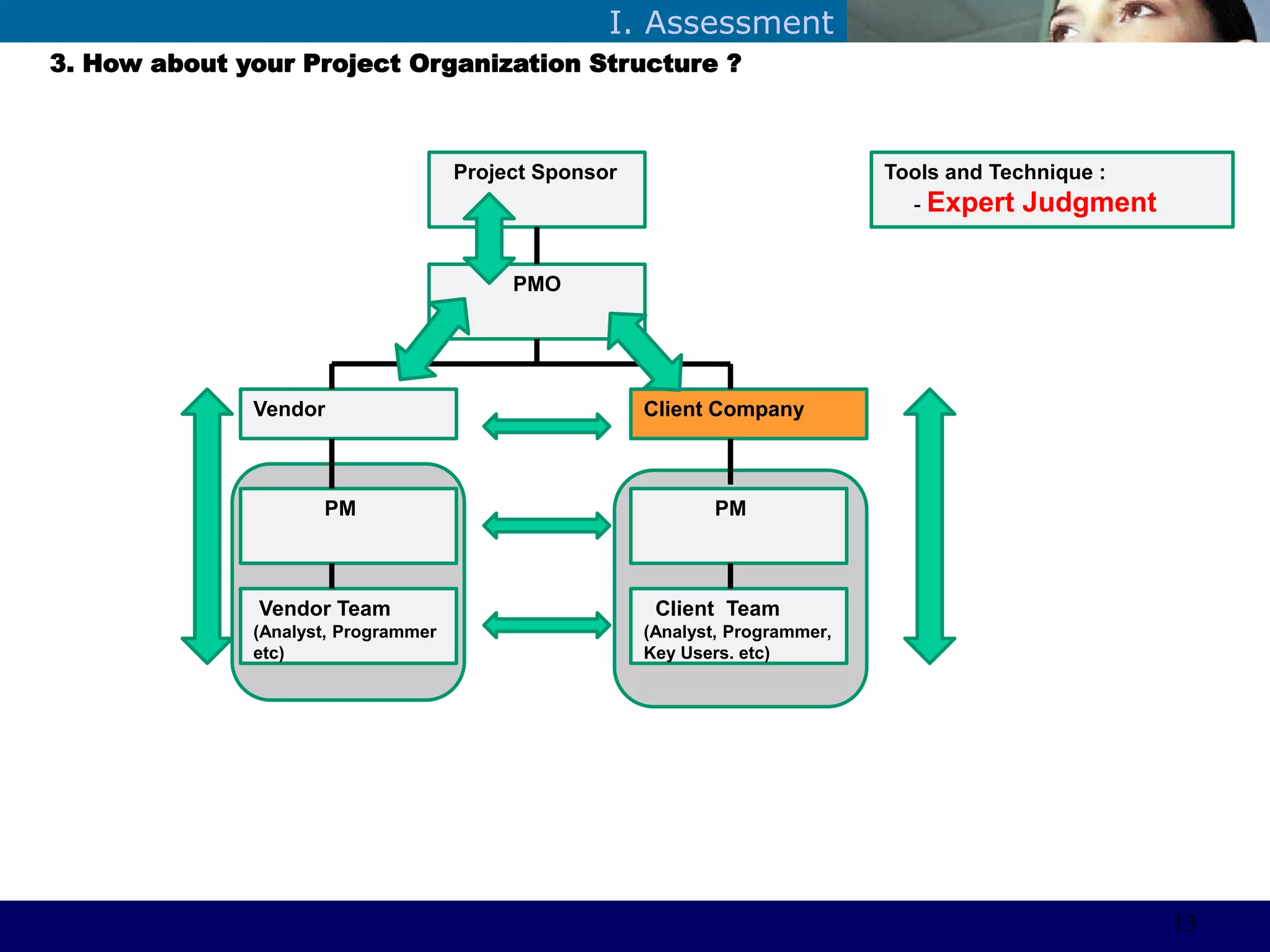

3. How about your Project Organization Structure ?
Client CompanyVendor
PMO
PM PM
Vendor Team
(Analyst, Programmer
etc)
Client Team
(Analyst, Programmer,
Key Users. etc)
Project Sponsor Tools and Technique :
- Expert Judgment
13
©Sabaruddinde AB
Perlunya IT DepartemenI. Assessment

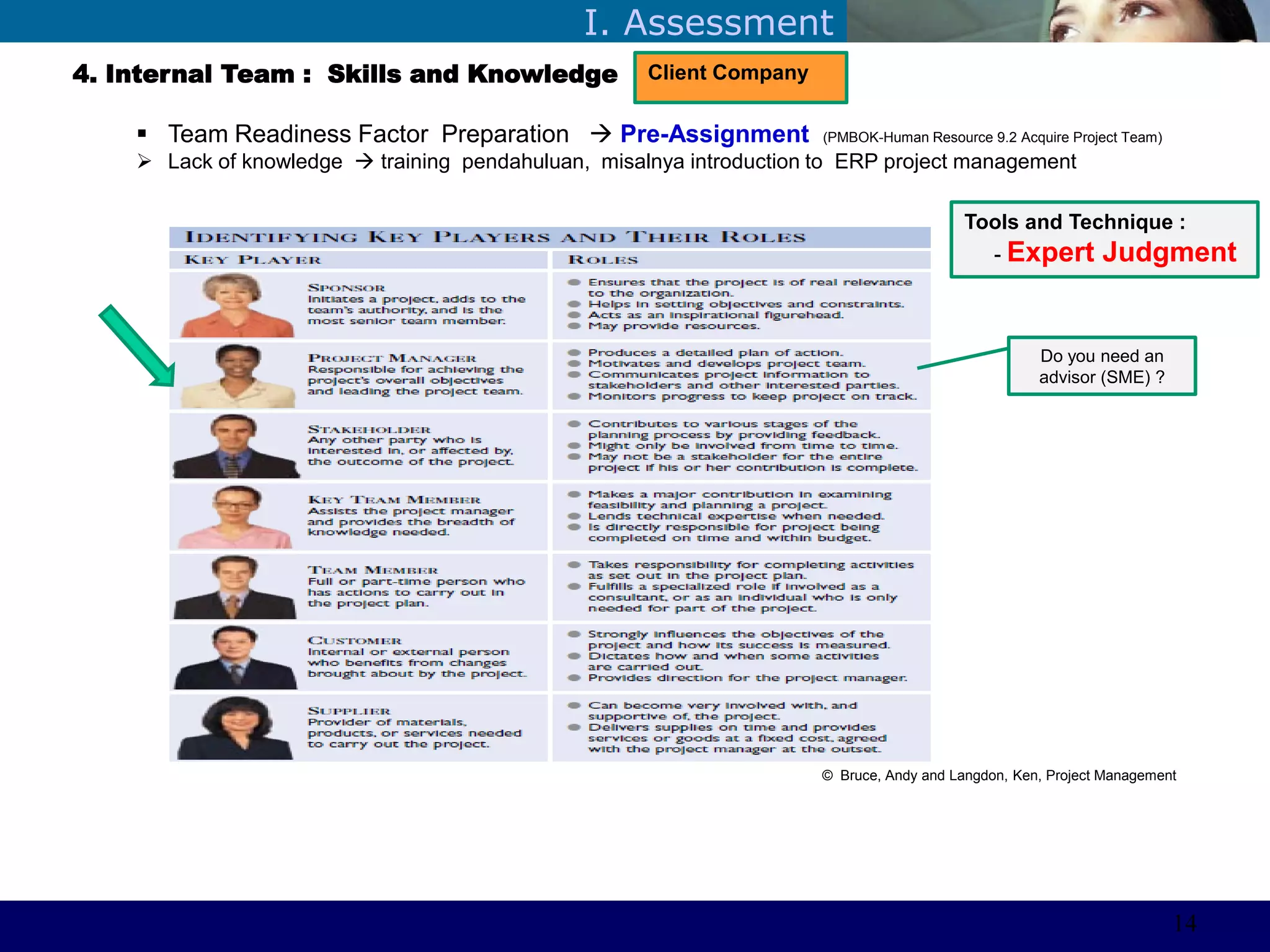

4. Internal Team : Skills and Knowledge
 Team Readiness Factor Preparation  Pre-Assignment (PMBOK-Human Resource 9.2 Acquire Project Team)
 Lack of knowledge  training pendahuluan, misalnya introduction to ERP project management
© Bruce, Andy and Langdon, Ken, Project Management
Client Company
Do you need an
advisor (SME) ?
Tools and Technique :
- Expert Judgment
14
©Sabaruddinde AB
Perlunya IT DepartemenI. Assessment

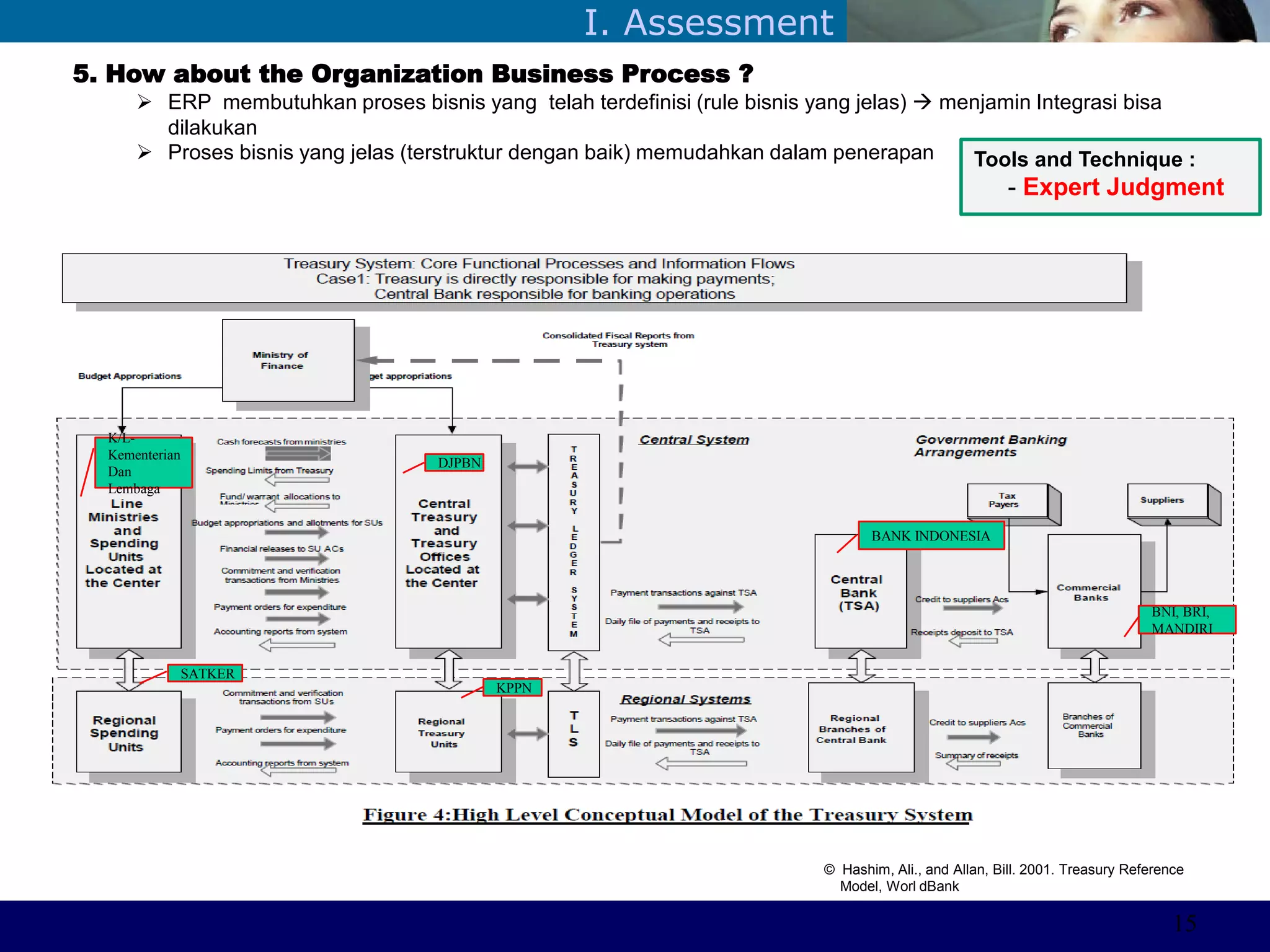

5. How about the Organization Business Process ?
 ERP membutuhkan proses bisnis yang telah terdefinisi (rule bisnis yang jelas)  menjamin Integrasi bisa
dilakukan
 Proses bisnis yang jelas (terstruktur dengan baik) memudahkan dalam penerapan
SATKER
KPPN
BANK INDONESIA
BNI, BRI,
MANDIRI
DJPBN
K/L-
Kementerian
Dan
Lembaga
© Hashim, Ali., and Allan, Bill. 2001. Treasury Reference
Model, Worl dBank
Tools and Technique :
- Expert Judgment
15
©Sabaruddinde AB

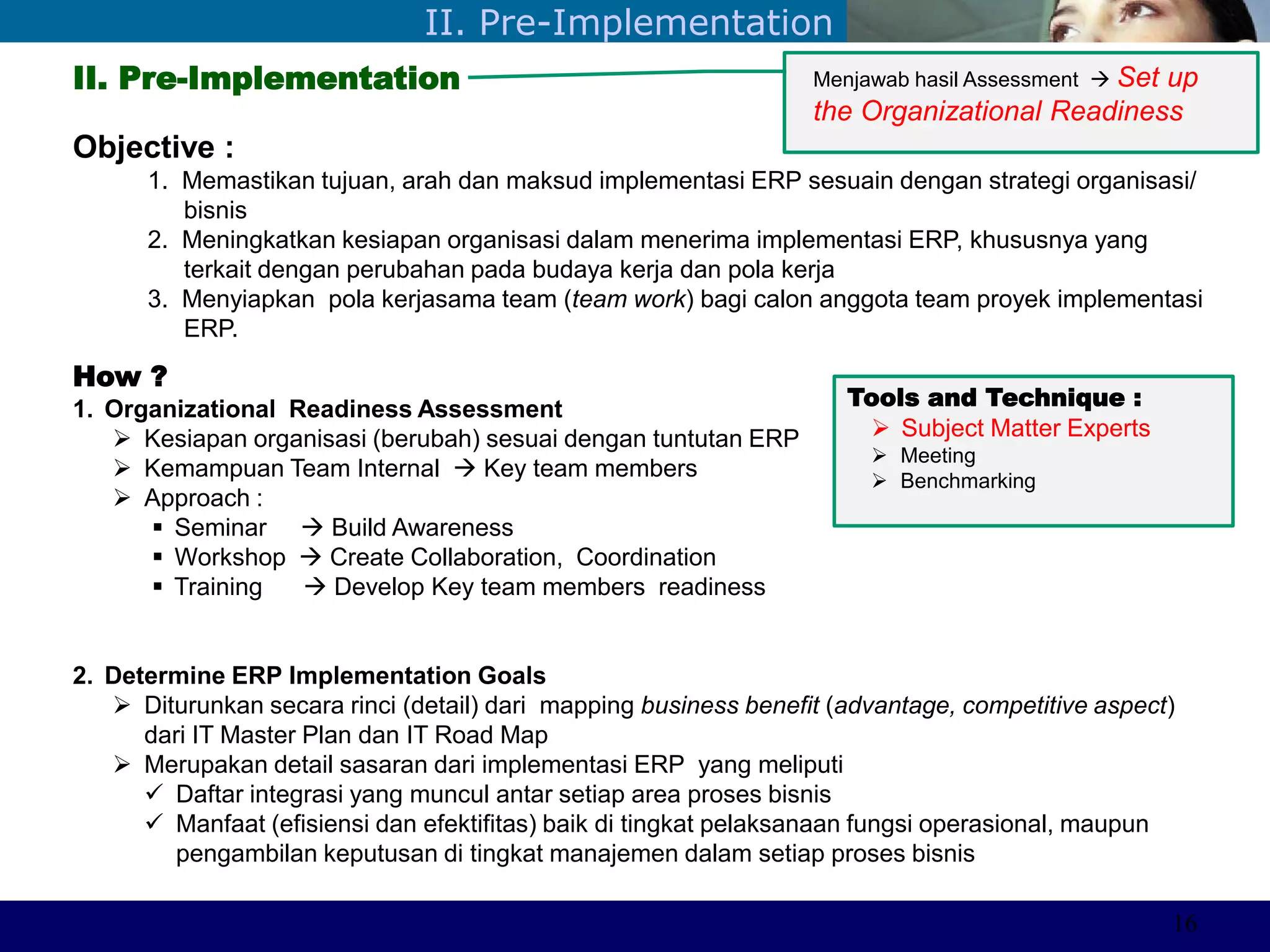

Perlunya IT DepartemenII. Pre-Implementation
II. Pre-Implementation
Objective :
1. Memastikan tujuan, arah dan maksud implementasi ERP sesuain dengan strategi organisasi/
bisnis
2. Meningkatkan kesiapan organisasi dalam menerima implementasi ERP, khususnya yang
terkait dengan perubahan pada budaya kerja dan pola kerja
3. Menyiapkan pola kerjasama team (team work) bagi calon anggota team proyek implementasi
ERP.
How ?
1. Organizational Readiness Assessment
 Kesiapan organisasi (berubah) sesuai dengan tuntutan ERP
 Kemampuan Team Internal  Key team members
 Approach :
 Seminar  Build Awareness
 Workshop  Create Collaboration, Coordination
 Training  Develop Key team members readiness
2. Determine ERP Implementation Goals
 Diturunkan secara rinci (detail) dari mapping business benefit (advantage, competitive aspect)
dari IT Master Plan dan IT Road Map
 Merupakan detail sasaran dari implementasi ERP yang meliputi
 Daftar integrasi yang muncul antar setiap area proses bisnis
 Manfaat (efisiensi dan efektifitas) baik di tingkat pelaksanaan fungsi operasional, maupun
pengambilan keputusan di tingkat manajemen dalam setiap proses bisnis
Tools and Technique :
 Subject Matter Experts
 Meeting
 Benchmarking
Menjawab hasil Assessment  Set up
the Organizational Readiness
16
©Sabaruddinde AB
Perlunya IT DepartemenII. Pre-Implementation
How ? (cont’d)

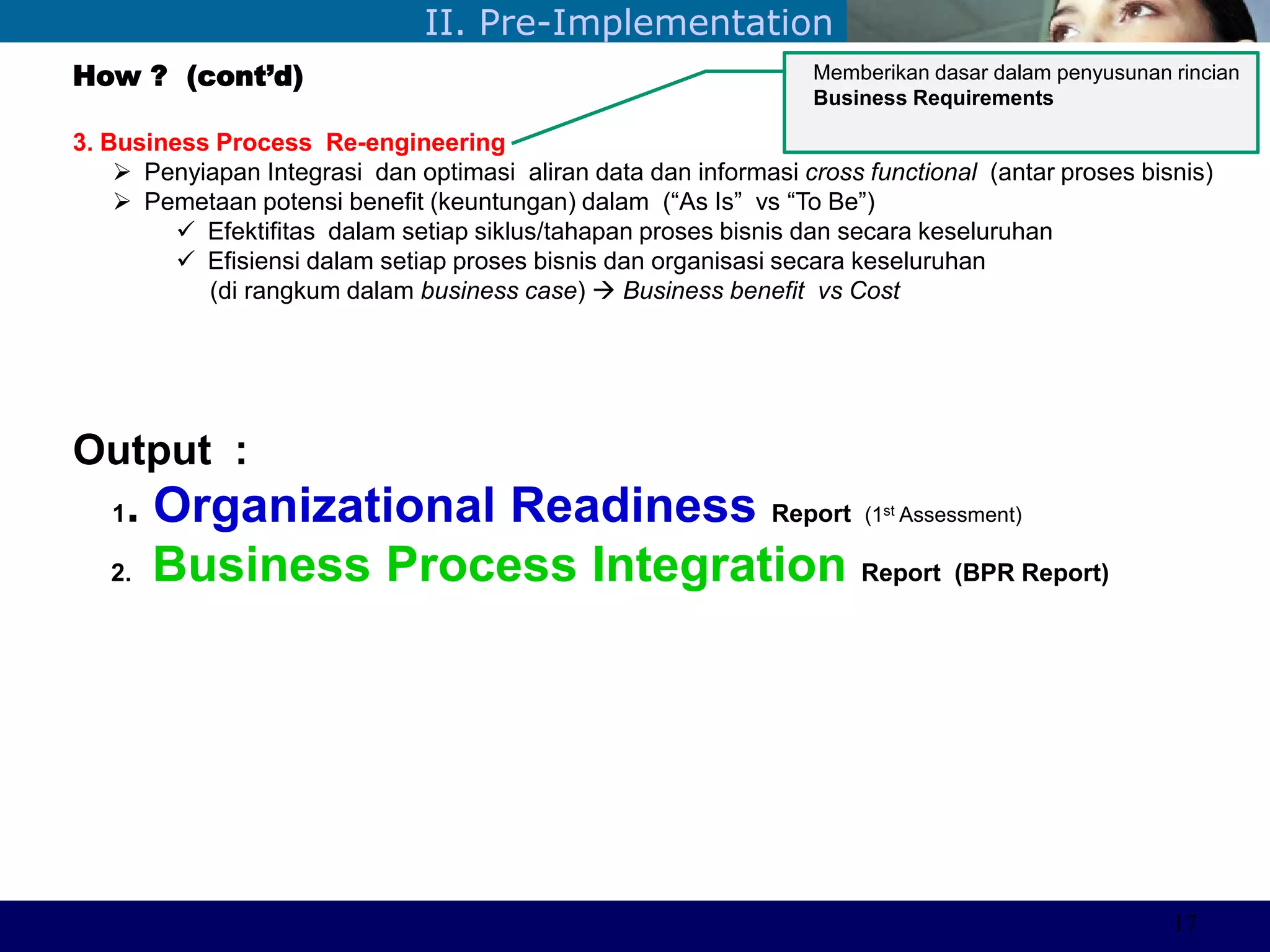

3. Business Process Re-engineering
 Penyiapan Integrasi dan optimasi aliran data dan informasi cross functional (antar proses bisnis)
 Pemetaan potensi benefit (keuntungan) dalam (―As Is‖ vs ―To Be‖)
 Efektifitas dalam setiap siklus/tahapan proses bisnis dan secara keseluruhan
 Efisiensi dalam setiap proses bisnis dan organisasi secara keseluruhan
(di rangkum dalam business case)  Business benefit vs Cost
Output :
1. Organizational Readiness Report (1st Assessment)
2. Business Process Integration Report (BPR Report)
Memberikan dasar dalam penyusunan rincian
Business Requirements
17

©Sabaruddinde AB

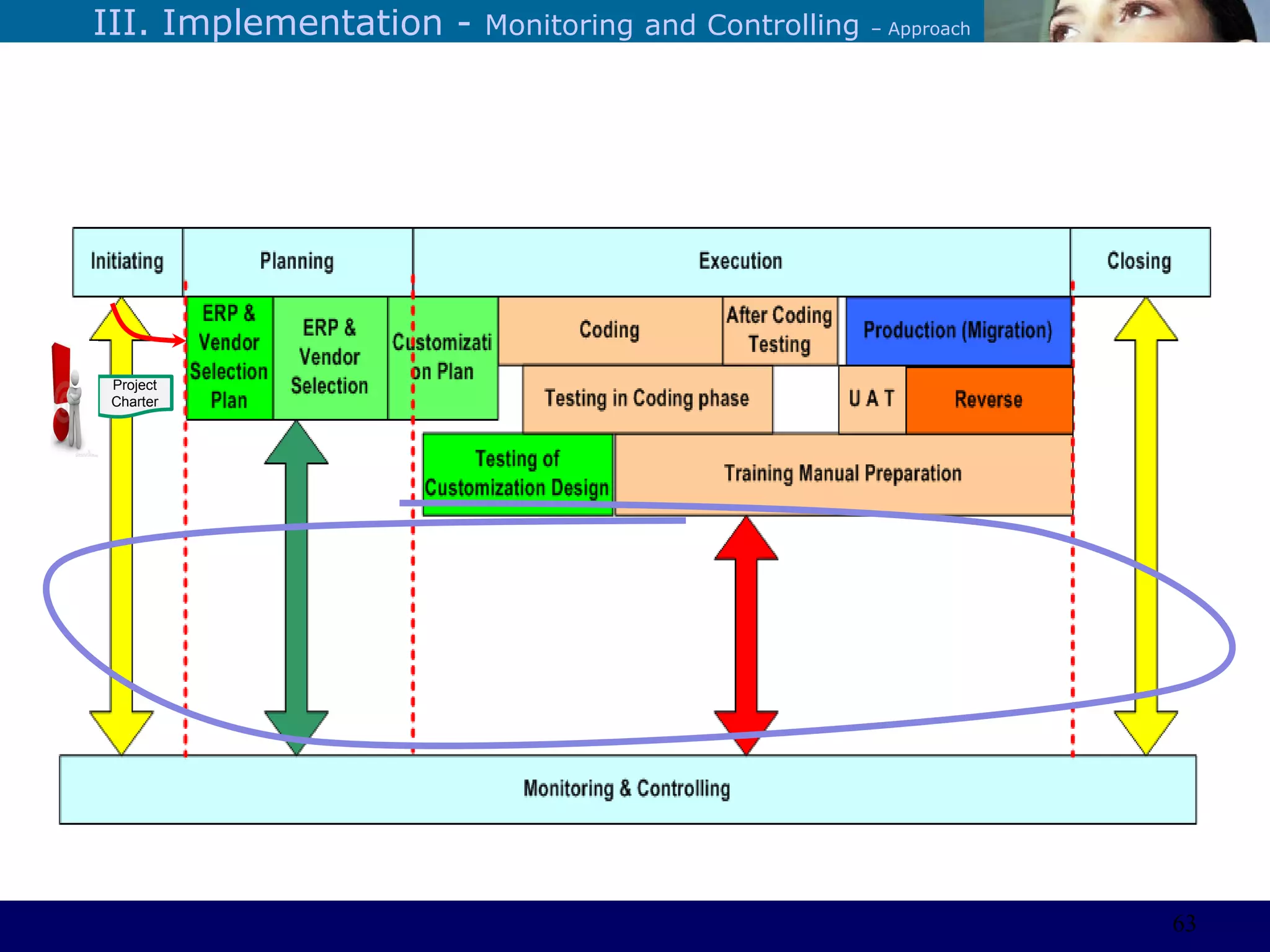

Perlunya IT DepartemenIII. Implementation

1. Initiating
Project Manager Assignment
Tools and Technique :
 Expert Judgment (SME)
 Facilitation Techniques
(Brainstorming, Focus Group)
Who is Project Manager ?
A person that is RESPONSIBLE for : achieving the project’s overall objectives and
leading the project team.

Project Manager Responsibilities
 Providing thought leadership and vision
 Planning and organizing the project
 Organizing and managing the project team
 Estimating cost and developing project budget
 Monitoring and controlling the project schedule
 Ensuring the quality of the final result
 Stakeholder Engagement
Educate the stakeholders – to
understand what the new ―systems‖
(to be) is designed to
18
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Initiating
You as a ERP Project Manager

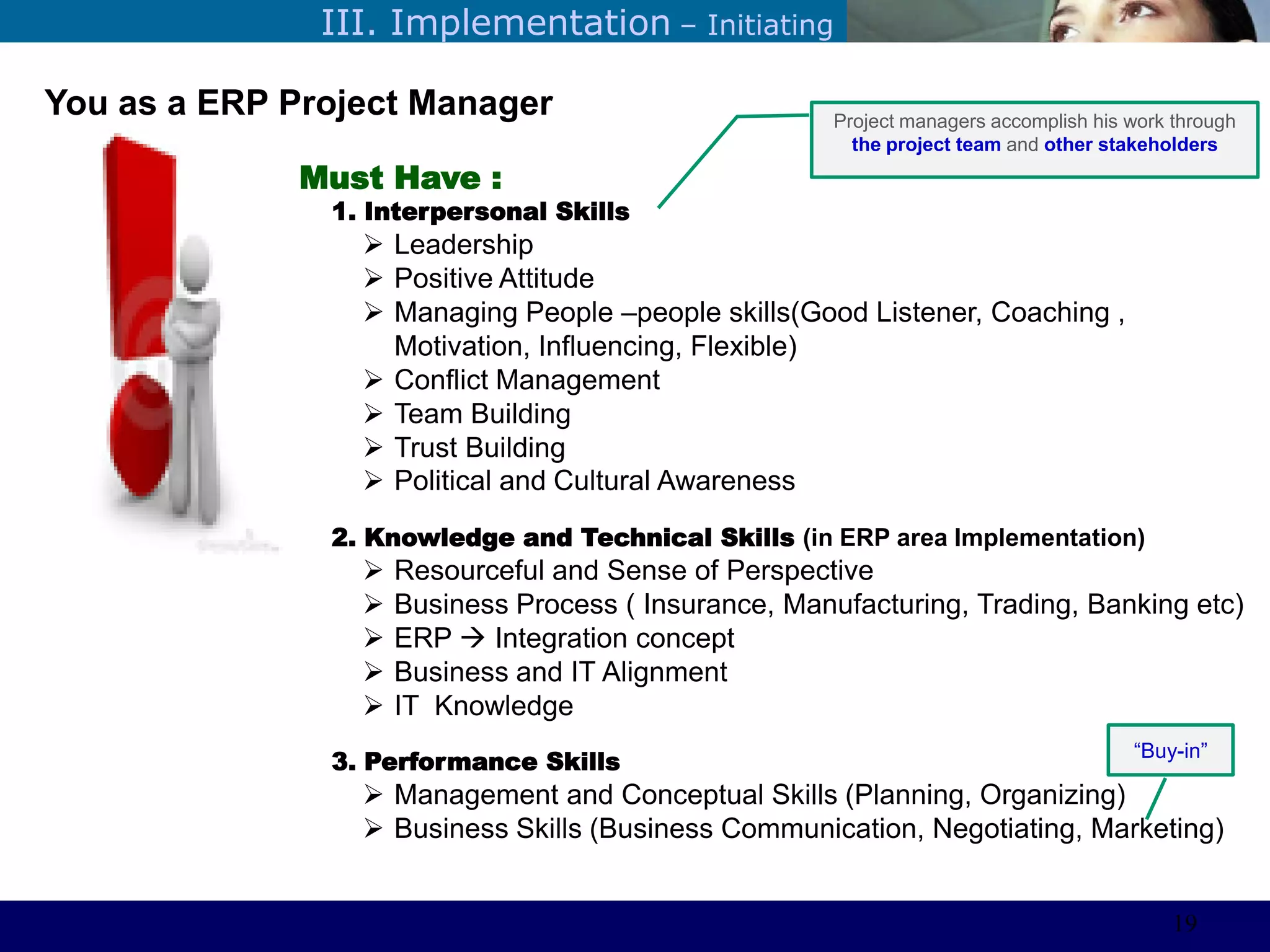

Must Have :
1. Interpersonal Skills
 Leadership
 Positive Attitude
 Managing People –people skills(Good Listener, Coaching ,
Motivation, Influencing, Flexible)
 Conflict Management
 Team Building
 Trust Building
 Political and Cultural Awareness
2. Knowledge and Technical Skills (in ERP area Implementation)
 Resourceful and Sense of Perspective
 Business Process ( Insurance, Manufacturing, Trading, Banking etc)
 ERP  Integration concept
 Business and IT Alignment
 IT Knowledge
3. Performance Skills
 Management and Conceptual Skills (Planning, Organizing)
 Business Skills (Business Communication, Negotiating, Marketing)
Project managers accomplish his work through
the project team and other stakeholders
―Buy-in‖
19
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation - Initiating .
How ? By :
 Creating and maintaining an environment -that is conducive-, and results
in the accomplishment of meaningful project work.
Source : Internet (www)
Use your communication
channel and tools, including
social media
20
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation - Initiating

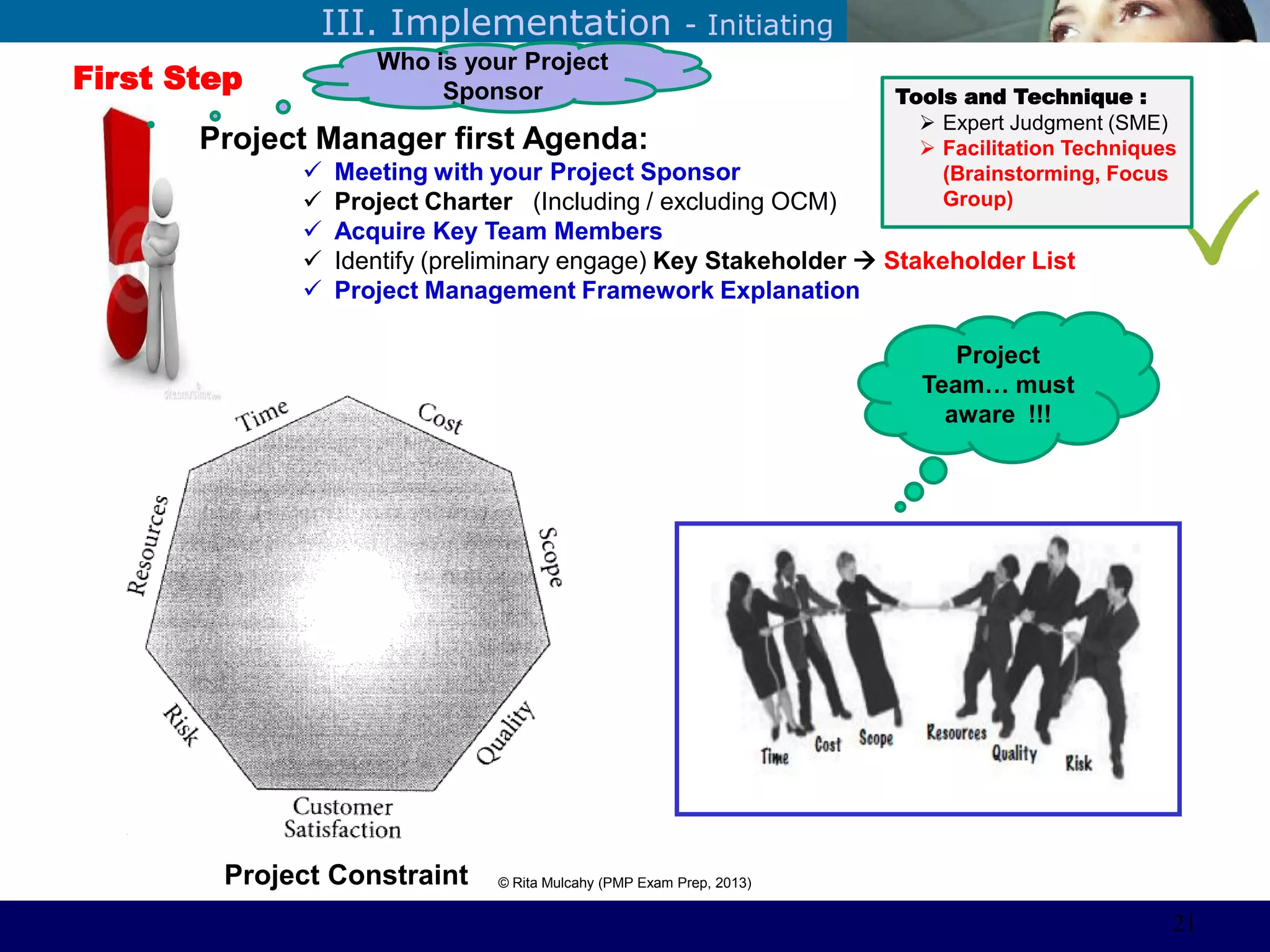

First Step
Project Constraint © Rita Mulcahy (PMP Exam Prep, 2013)
Project
Team… must
aware !!!
Tools and Technique :
 Expert Judgment (SME)
 Facilitation Techniques
(Brainstorming, Focus
Group)
Project Manager first Agenda:
 Meeting with your Project Sponsor
 Project Charter (Including / excluding OCM)
 Acquire Key Team Members
 Identify (preliminary engage) Key Stakeholder  Stakeholder List
 Project Management Framework Explanation
Who is your Project
Sponsor
21
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation - Initiating

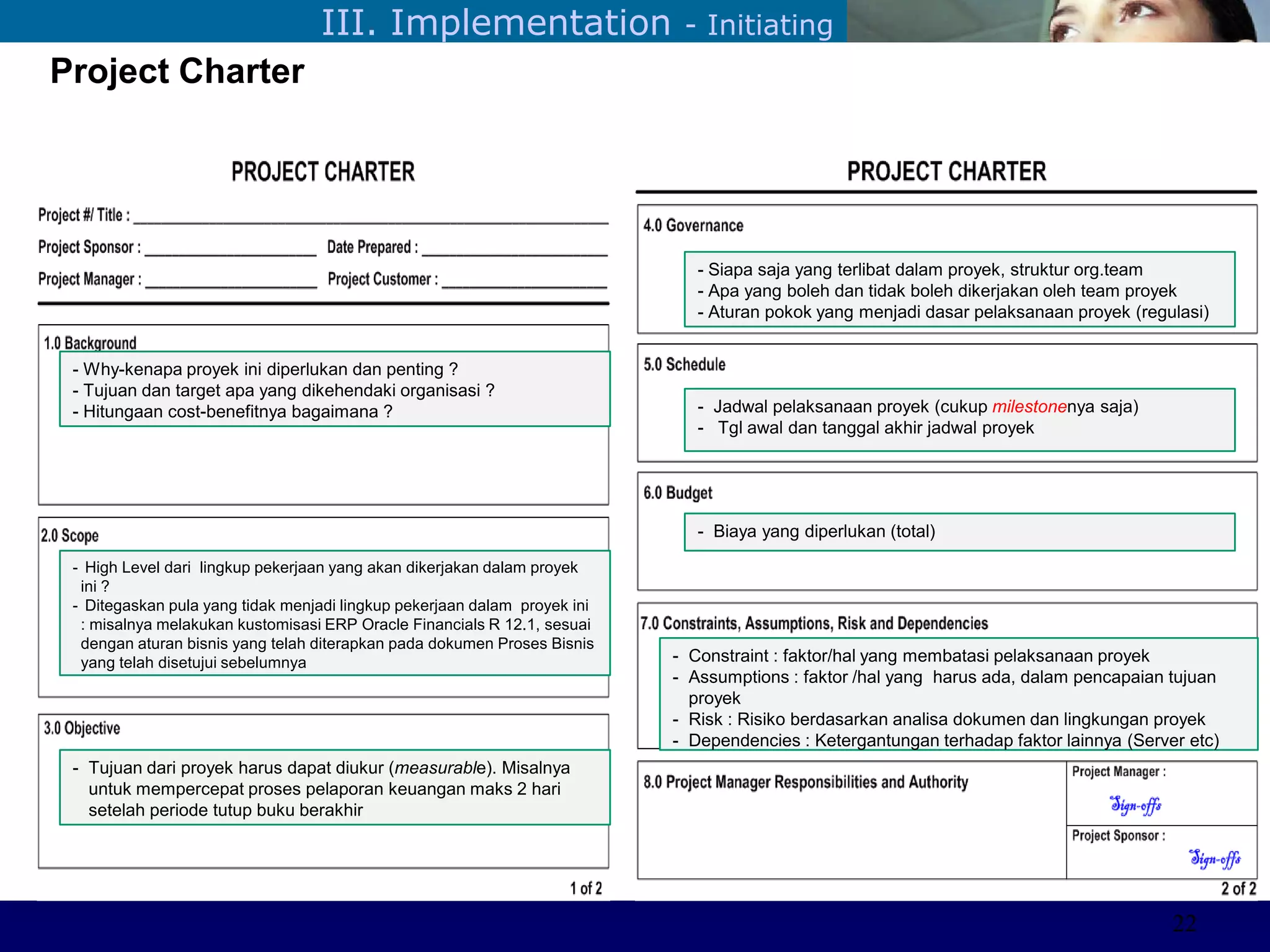

Project Charter
- Why-kenapa proyek ini diperlukan dan penting ?
- Tujuan dan target apa yang dikehendaki organisasi ?
- Hitungaan cost-benefitnya bagaimana ?
- High Level dari lingkup pekerjaan yang akan dikerjakan dalam proyek
ini ?
- Ditegaskan pula yang tidak menjadi lingkup pekerjaan dalam proyek ini
: misalnya melakukan kustomisasi ERP Oracle Financials R 12.1, sesuai
dengan aturan bisnis yang telah diterapkan pada dokumen Proses Bisnis
yang telah disetujui sebelumnya
- Siapa saja yang terlibat dalam proyek, struktur org.team
- Apa yang boleh dan tidak boleh dikerjakan oleh team proyek
- Aturan pokok yang menjadi dasar pelaksanaan proyek (regulasi)
- Tujuan dari proyek harus dapat diukur (measurable). Misalnya
untuk mempercepat proses pelaporan keuangan maks 2 hari
setelah periode tutup buku berakhir
- Jadwal pelaksanaan proyek (cukup milestonenya saja)
- Tgl awal dan tanggal akhir jadwal proyek
- Biaya yang diperlukan (total)
- Constraint : faktor/hal yang membatasi pelaksanaan proyek
- Assumptions : faktor /hal yang harus ada, dalam pencapaian tujuan
proyek
- Risk : Risiko berdasarkan analisa dokumen dan lingkungan proyek
- Dependencies : Ketergantungan terhadap faktor lainnya (Server etc)
22
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation - Initiating

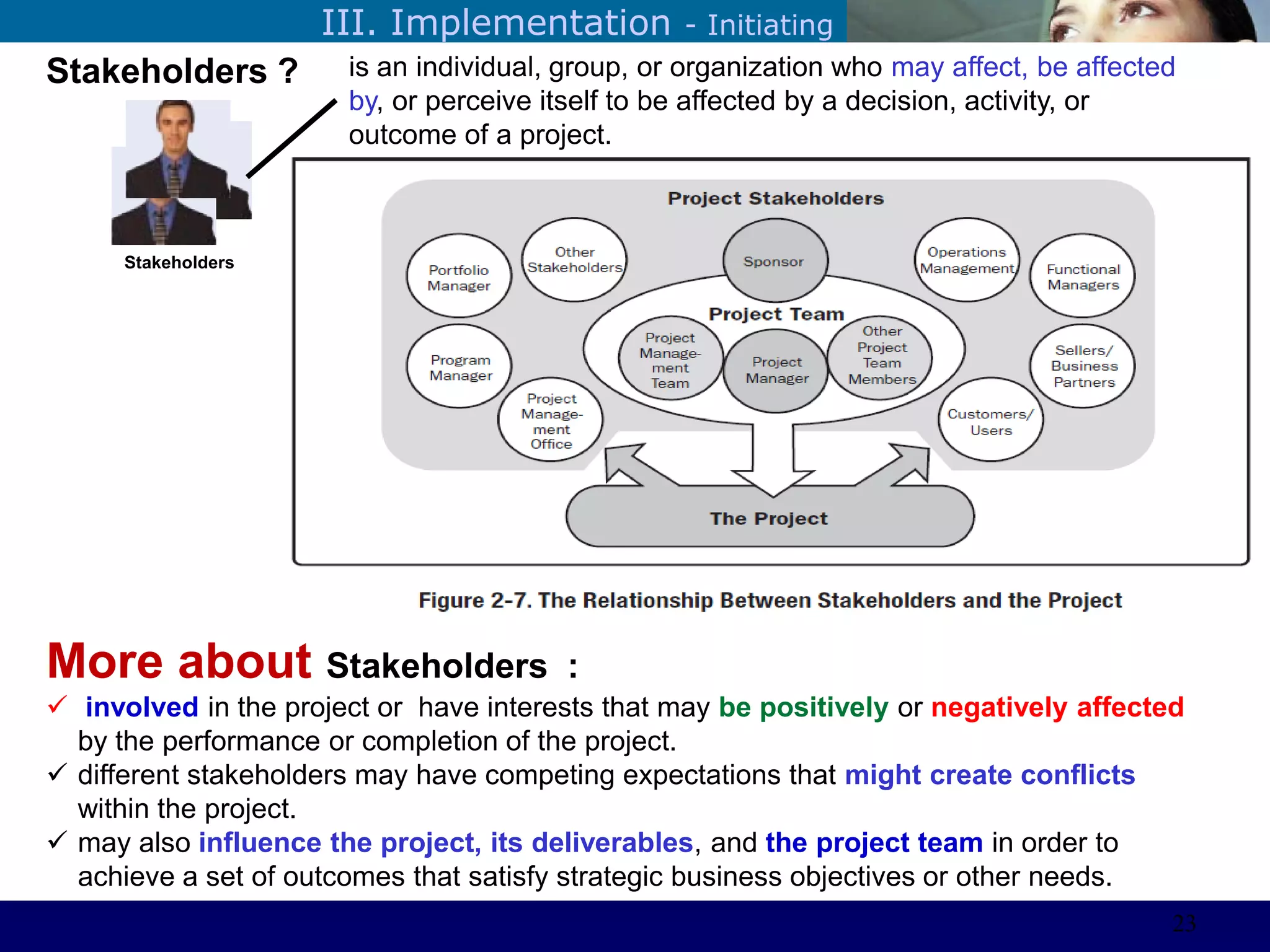

Stakeholders ?
Stakeholders
is an individual, group, or organization who may affect, be affected
by, or perceive itself to be affected by a decision, activity, or
outcome of a project.
More about Stakeholders :
 involved in the project or have interests that may be positively or negatively affected
by the performance or completion of the project.
 different stakeholders may have competing expectations that might create conflicts
within the project.
 may also influence the project, its deliverables, and the project team in order to
achieve a set of outcomes that satisfy strategic business objectives or other needs.
23
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation - Planning

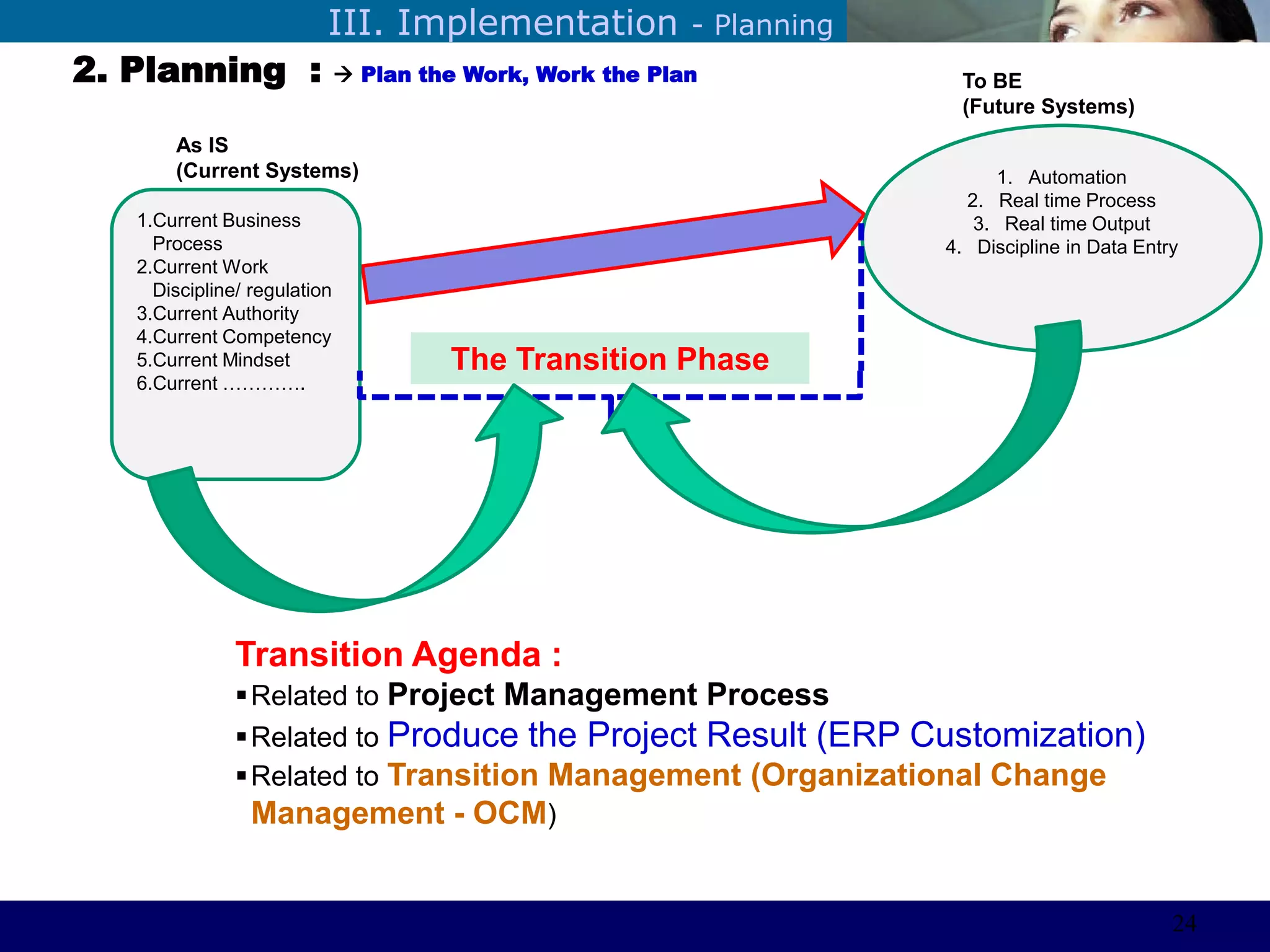

2. Planning :  Plan the Work, Work the Plan
As IS
(Current Systems)
1.Current Business
Process
2.Current Work
Discipline/ regulation
3.Current Authority
4.Current Competency
5.Current Mindset
6.Current ………….
1. Automation
2. Real time Process
3. Real time Output
4. Discipline in Data Entry
To BE
(Future Systems)
The Transition Phase
Transition Agenda :
Related to Project Management Process
Related to Produce the Project Result (ERP Customization)
Related to Transition Management (Organizational Change
Management - OCM)
24
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation - Planning
Your Planning Approach
Project
Management
ERP Implementation
Management
Organizational Change
Management
25
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation - Planning

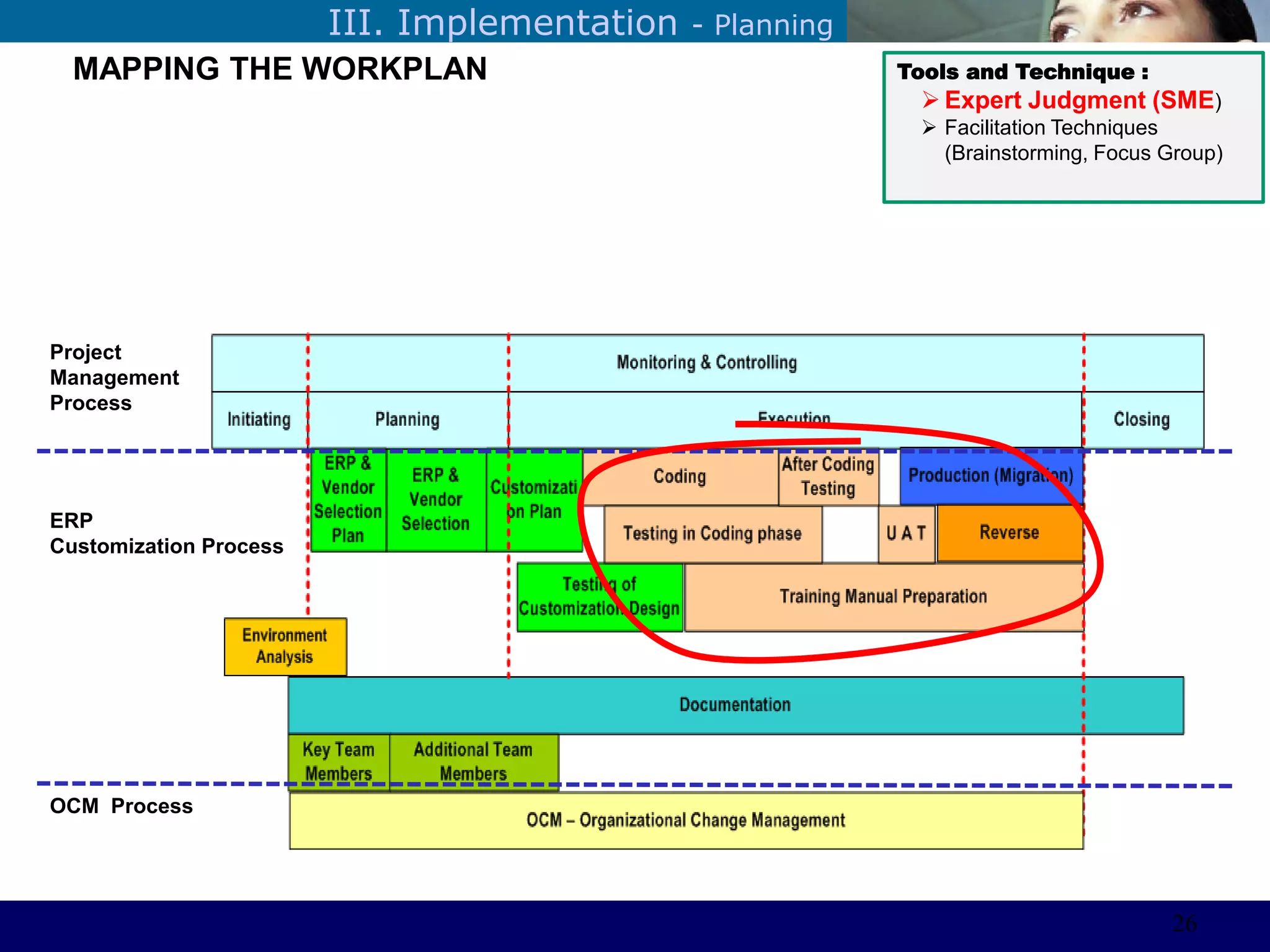

MAPPING THE WORKPLAN
Project
Management
Process
ERP
Customization Process
OCM Process
Tools and Technique :
 Expert Judgment (SME)
 Facilitation Techniques
(Brainstorming, Focus Group)
26
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation - Planning

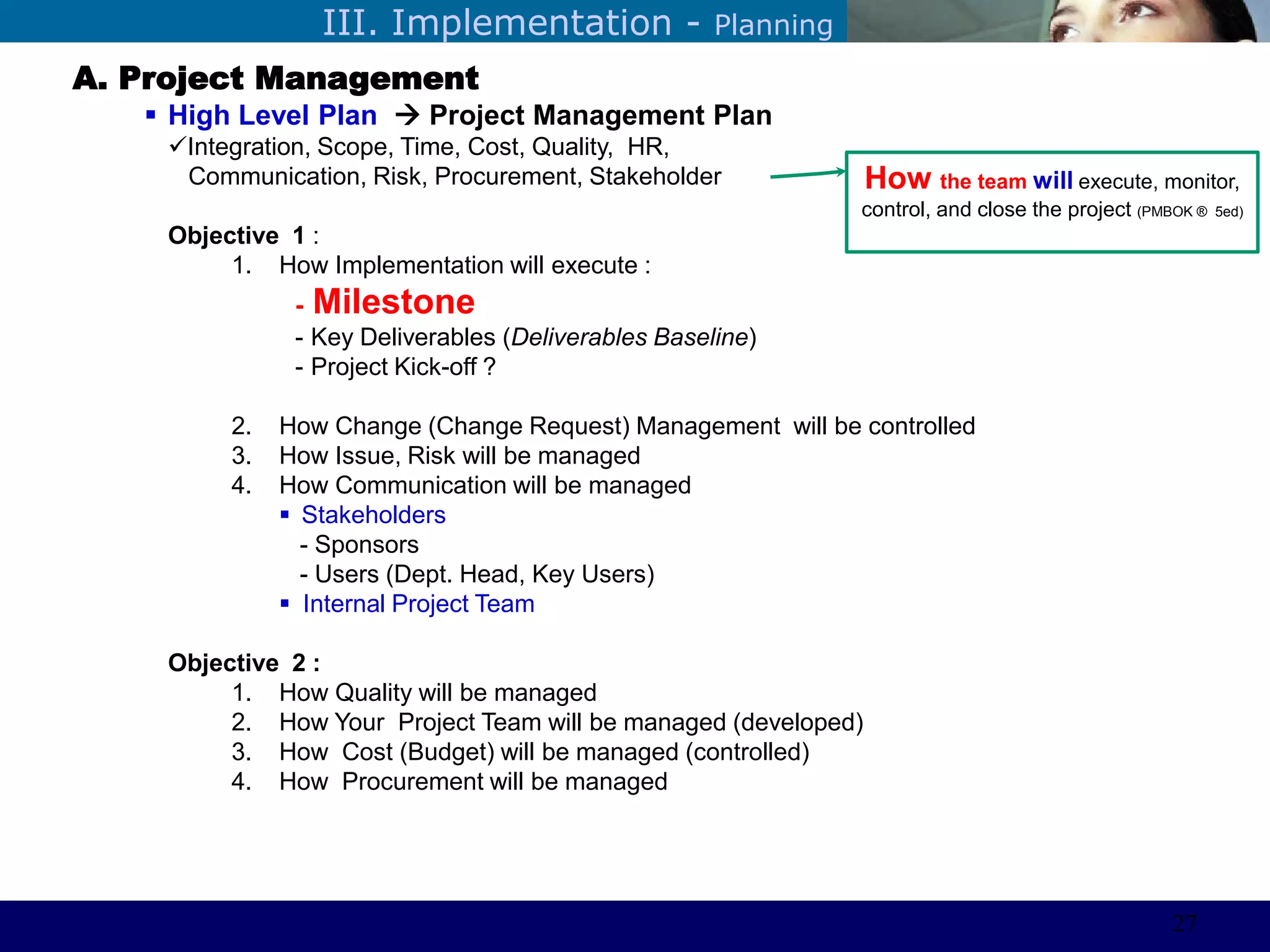

A. Project Management
 High Level Plan  Project Management Plan
Integration, Scope, Time, Cost, Quality, HR,
Communication, Risk, Procurement, Stakeholder
Objective 1 :
1. How Implementation will execute :
- Milestone
- Key Deliverables (Deliverables Baseline)
- Project Kick-off ?
2. How Change (Change Request) Management will be controlled
3. How Issue, Risk will be managed
4. How Communication will be managed
 Stakeholders
- Sponsors
- Users (Dept. Head, Key Users)
 Internal Project Team
Objective 2 :
1. How Quality will be managed
2. How Your Project Team will be managed (developed)
3. How Cost (Budget) will be managed (controlled)
4. How Procurement will be managed
How the team will execute, monitor,
control, and close the project (PMBOK ® 5ed)
27
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation - Planning

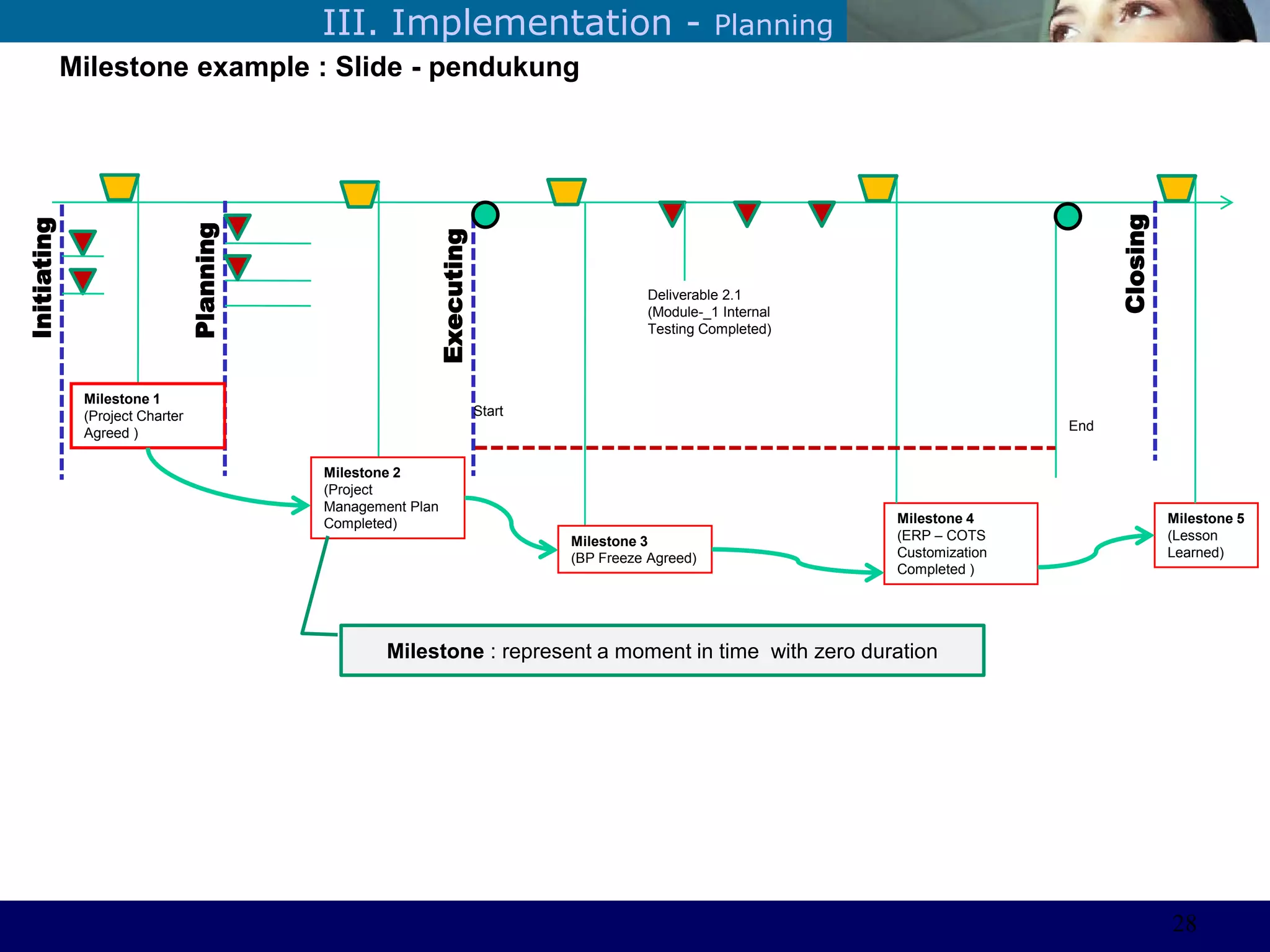

Milestone example : Slide - pendukung
Initiating
Planning
Executing
Start
Milestone 3
(BP Freeze Agreed)
Milestone 4
(ERP – COTS
Customization
Completed )
Deliverable 2.1
(Module-_1 Internal
Testing Completed)
Milestone 1
(Project Charter
Agreed ) End
Closing
Milestone 5
(Lesson
Learned)
Milestone 2
(Project
Management Plan
Completed)
Milestone : represent a moment in time with zero duration
28
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – Project Management Plan

Example form :
Process Tools and Techniques : Menjelaskan
tools dan teknis khusus yang akan dipergunakan
untuk masing-masing proses.
misalnya : sofware tertentu (PMIS, costing
software or method)
Project Management and Tailoring Decisions :
Keputusan, kebijakan, pendekatan (approach)
serta proses khusus (specific) yang
dipergunakan dalam setiap phase proyek
misalnya : Pendekatan yang ditempuh dalam
penanganan risiko, prinsip dalam pengelolaan
biaya dll.
29
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – Project Management Plan

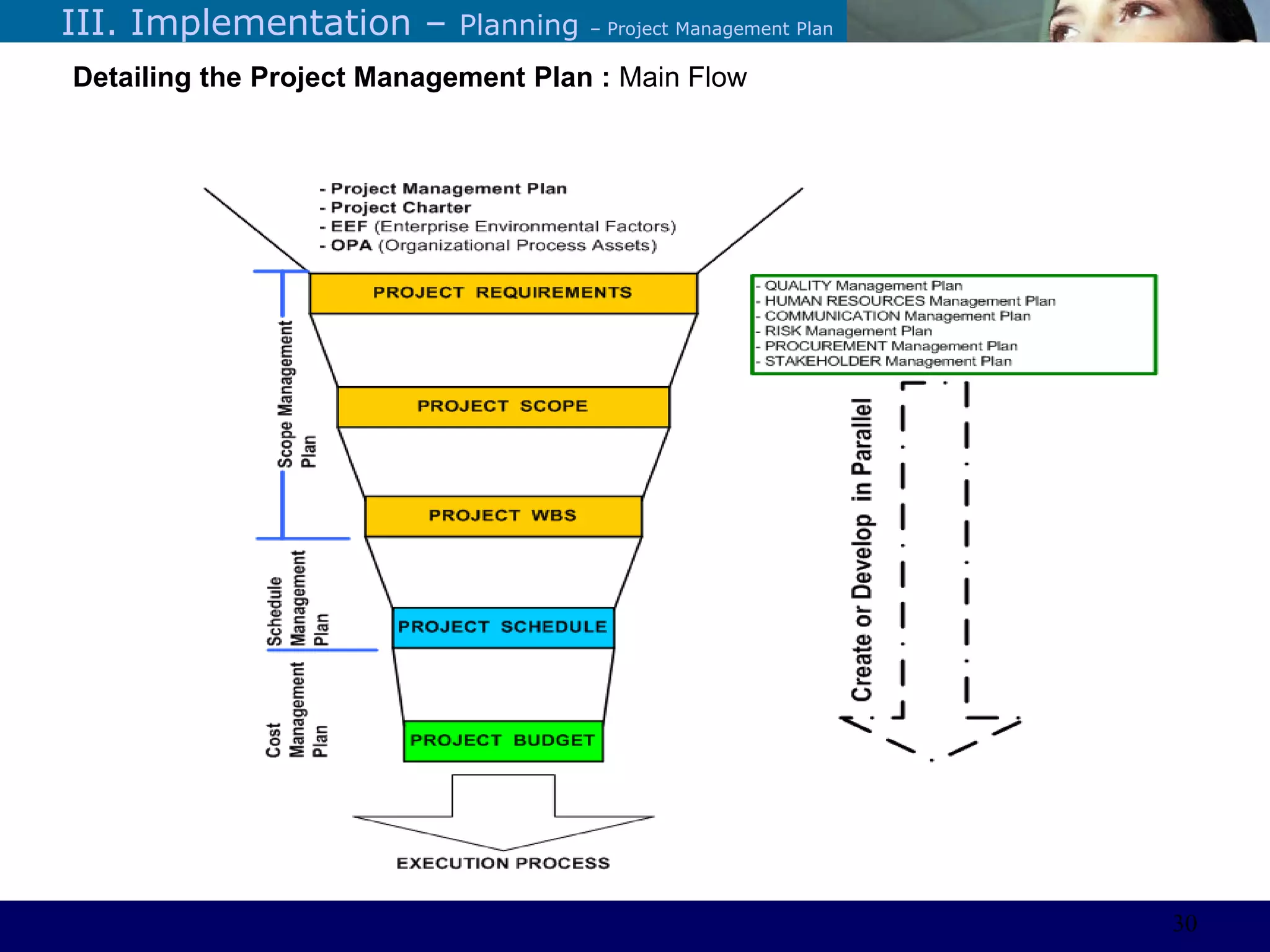

Detailing the Project Management Plan : Main Flow
Project Management and Tailoring Decisions :
Keputusan, kebijakan, pendekatan (approach)
serta proses khusus (specific) yang
dipergunakan dalam setiap phase proyek
misalnya : Pendekatan yang ditempuh dalam
penanganan risiko, prinsip dalam pengelolaan
biaya dll.
30
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning-Project Scope Management Plan

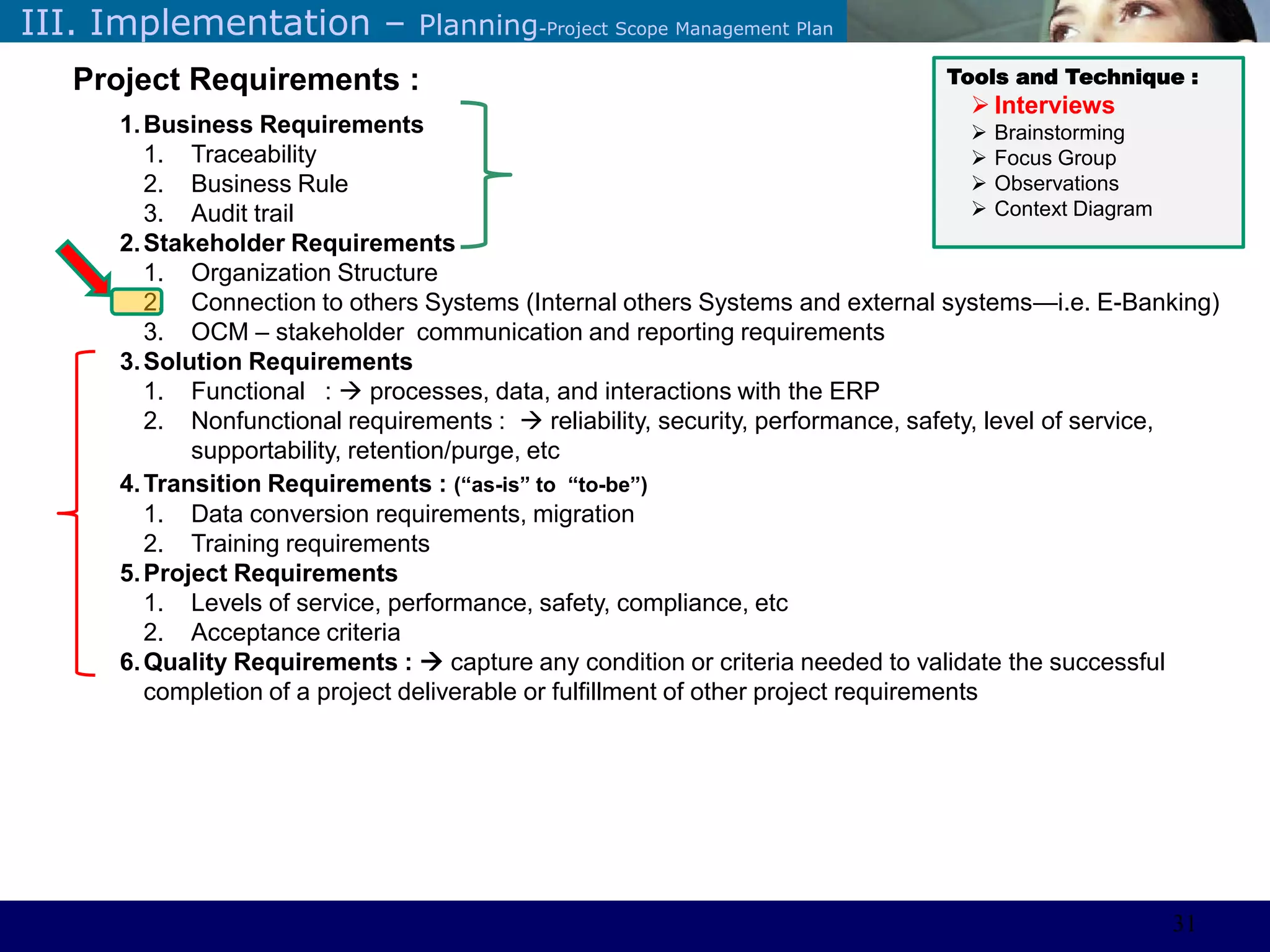

Project Requirements : Tools and Technique :
 Interviews
 Brainstorming
 Focus Group
 Observations
 Context Diagram
1.Business Requirements
1. Traceability
2. Business Rule
3. Audit trail
2.Stakeholder Requirements
1. Organization Structure
2. Connection to others Systems (Internal others Systems and external systems—i.e. E-Banking)
3. OCM – stakeholder communication and reporting requirements
3.Solution Requirements
1. Functional :  processes, data, and interactions with the ERP
2. Nonfunctional requirements :  reliability, security, performance, safety, level of service,
supportability, retention/purge, etc
4.Transition Requirements : (“as-is” to “to-be”)
1. Data conversion requirements, migration
2. Training requirements
5.Project Requirements
1. Levels of service, performance, safety, compliance, etc
2. Acceptance criteria
6.Quality Requirements :  capture any condition or criteria needed to validate the successful
completion of a project deliverable or fulfillment of other project requirements
31
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – Project Scope Management Plan

Scope Management Plan :
 Define Scope :  Project Scope Statement
Menjelaskan karakteristik produk, service atau result. Informasi ini bersifat
progressively elaborated dari penejelasan proyek dan dokumentasi requirements
Identifikasi deliverable (produk dan proyek) yang di setujui bersama dengan
stakeholders yang berkepentingan (especially customer/sponsor), termasuk laporan
pelaksanaan pengelolaan proyek dan dokumentasinya.
Kriteria yang diperlukan dalam persetujuan penerimaan deliverable oleh stakeholder.
Kriteria ini dapat dibuat untuk keseluruhan proyek untuk setiap komponen deliverable
Menjelaskan apa saja yang berada diluar scope proyek.
Menjelaskan faktor/hal-hal yang membatasi team proyek dalam pelaksanaan proyek
guna mencapai tujuan proyek (due dates yang sangat singkat, tingkat kesulitan
teknologi yang dipergunakan dsbnya)
Asumsi tentang deliverable, resources, estimate dan aspek lain dari proyek, yang
diharapkan menjadi nyata, namun belum divalidasi (Training ERP dilakukan setelah
Server Training yang dibeli dari pihak ketiga selesai di instal)
Tools and Technique :
 Product Analysis
 Expert Judgment
 Brainstorming
32
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning-Project Scope Management Plan

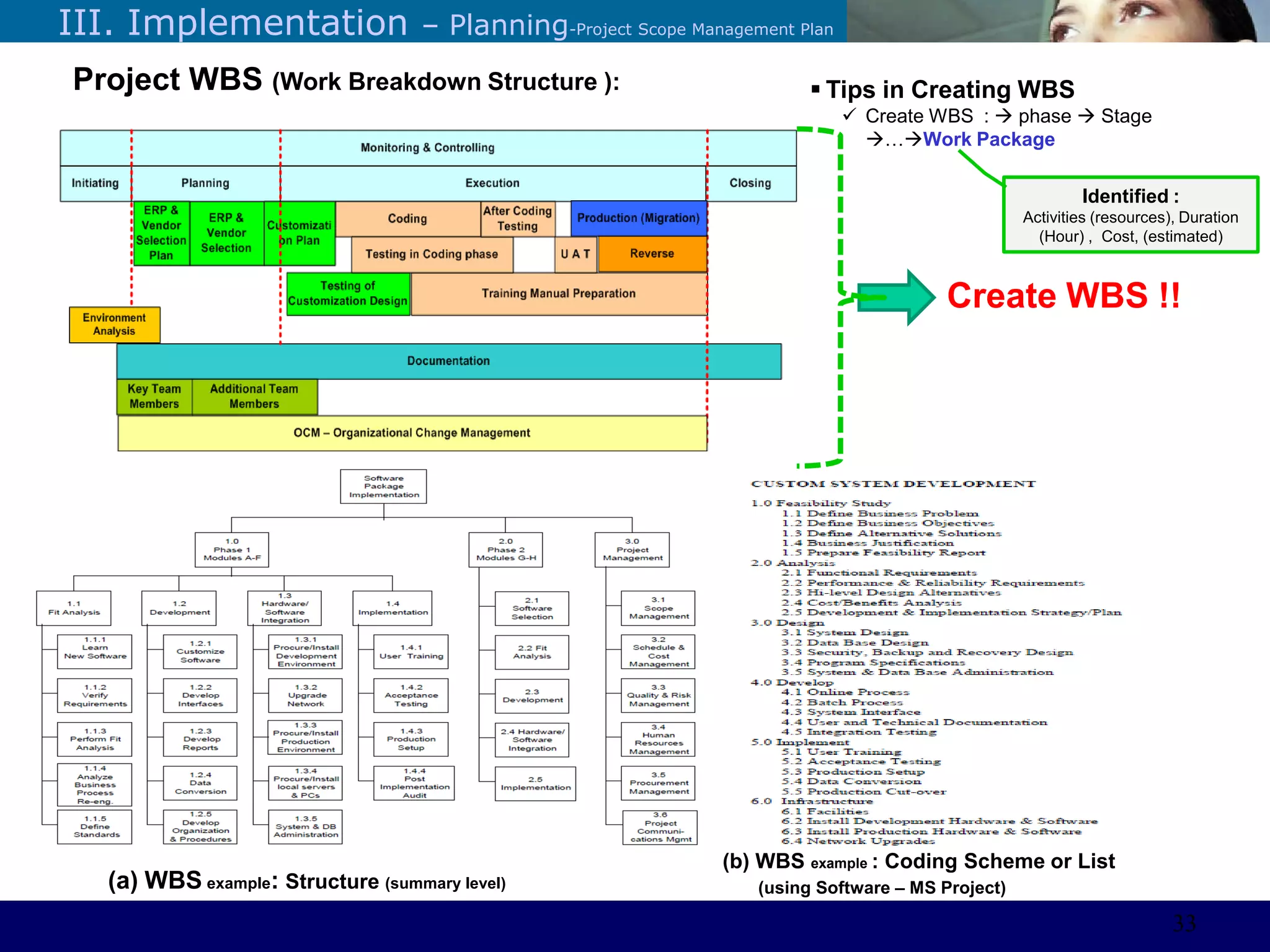

Project WBS (Work Breakdown Structure ):
Create WBS !!
 Tips in Creating WBS
 Create WBS :  phase  Stage
…Work Package
(a) WBS example: Structure (summary level)
(b) WBS example : Coding Scheme or List
(using Software – MS Project)
Identified :
Activities (resources), Duration
(Hour) , Cost, (estimated)
33
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning -Project Schedule Management Plan

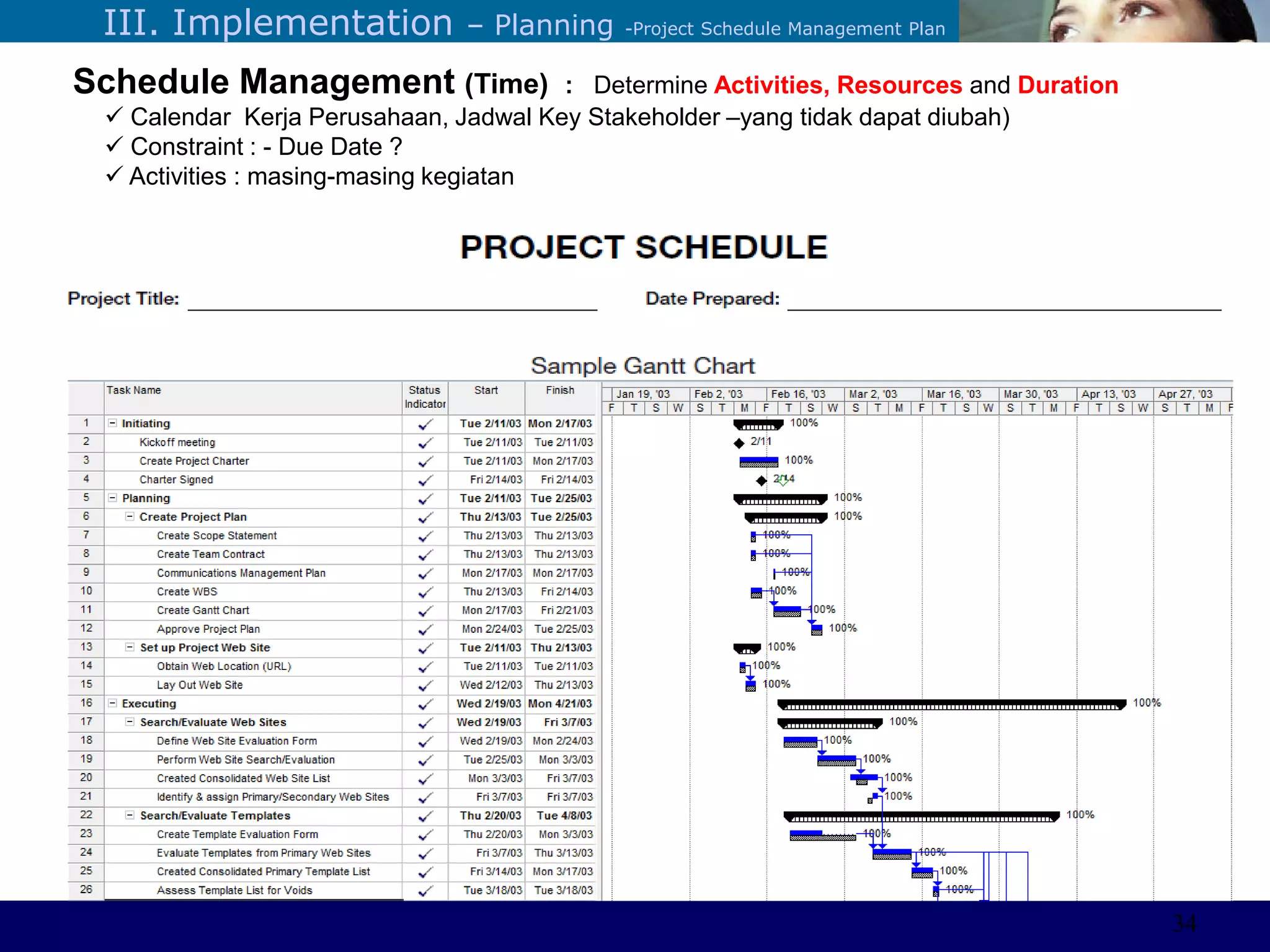

Schedule Management (Time) : Determine Activities, Resources and Duration
 Calendar Kerja Perusahaan, Jadwal Key Stakeholder –yang tidak dapat diubah)
 Constraint : - Due Date ?
 Activities : masing-masing kegiatan
34
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – Project Cost Management Plan

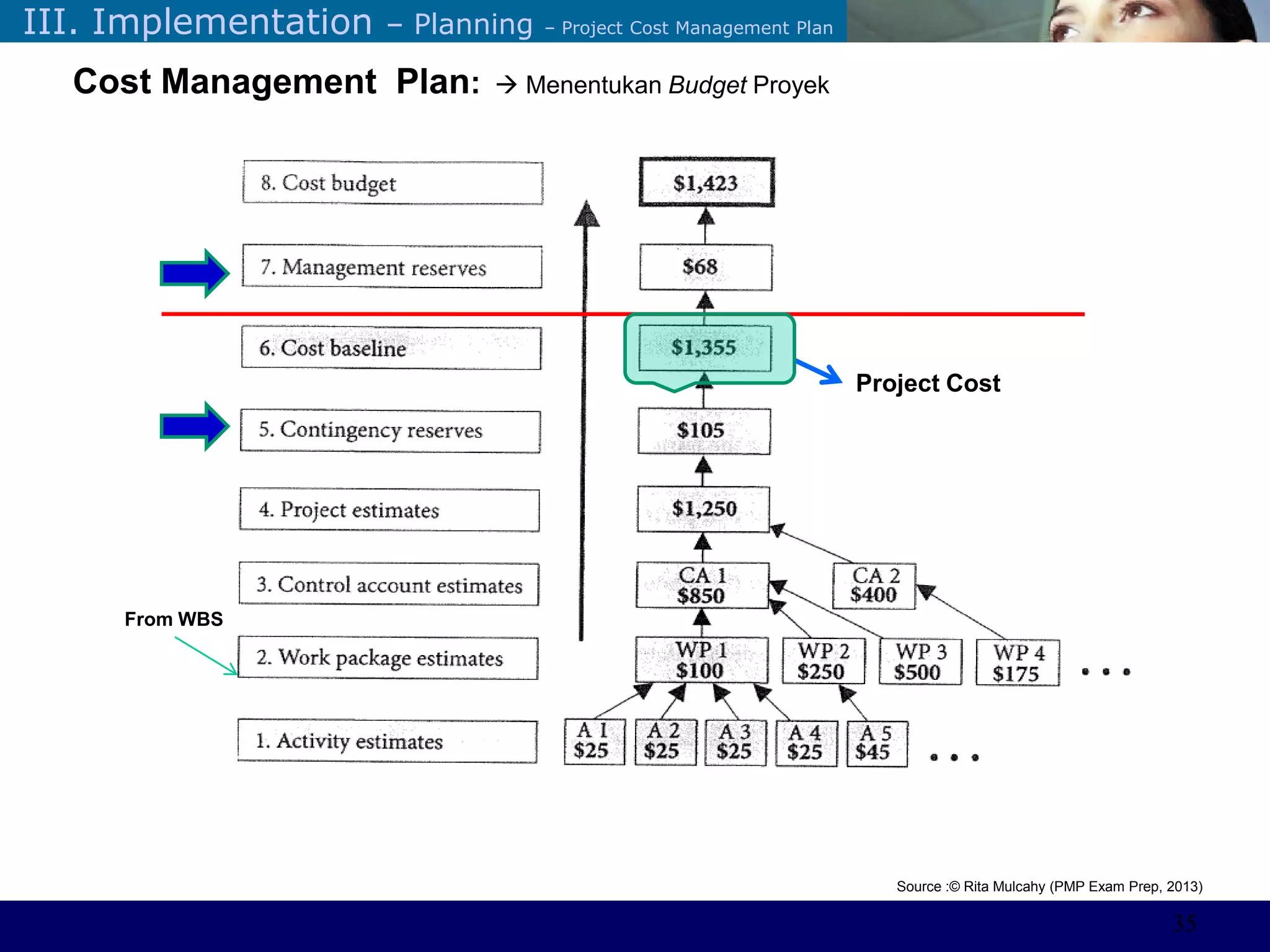

Cost Management Plan:  Menentukan Budget Proyek
Source :© Rita Mulcahy (PMP Exam Prep, 2013)
Project Cost
From WBS
35
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – Project Communication Management Plan

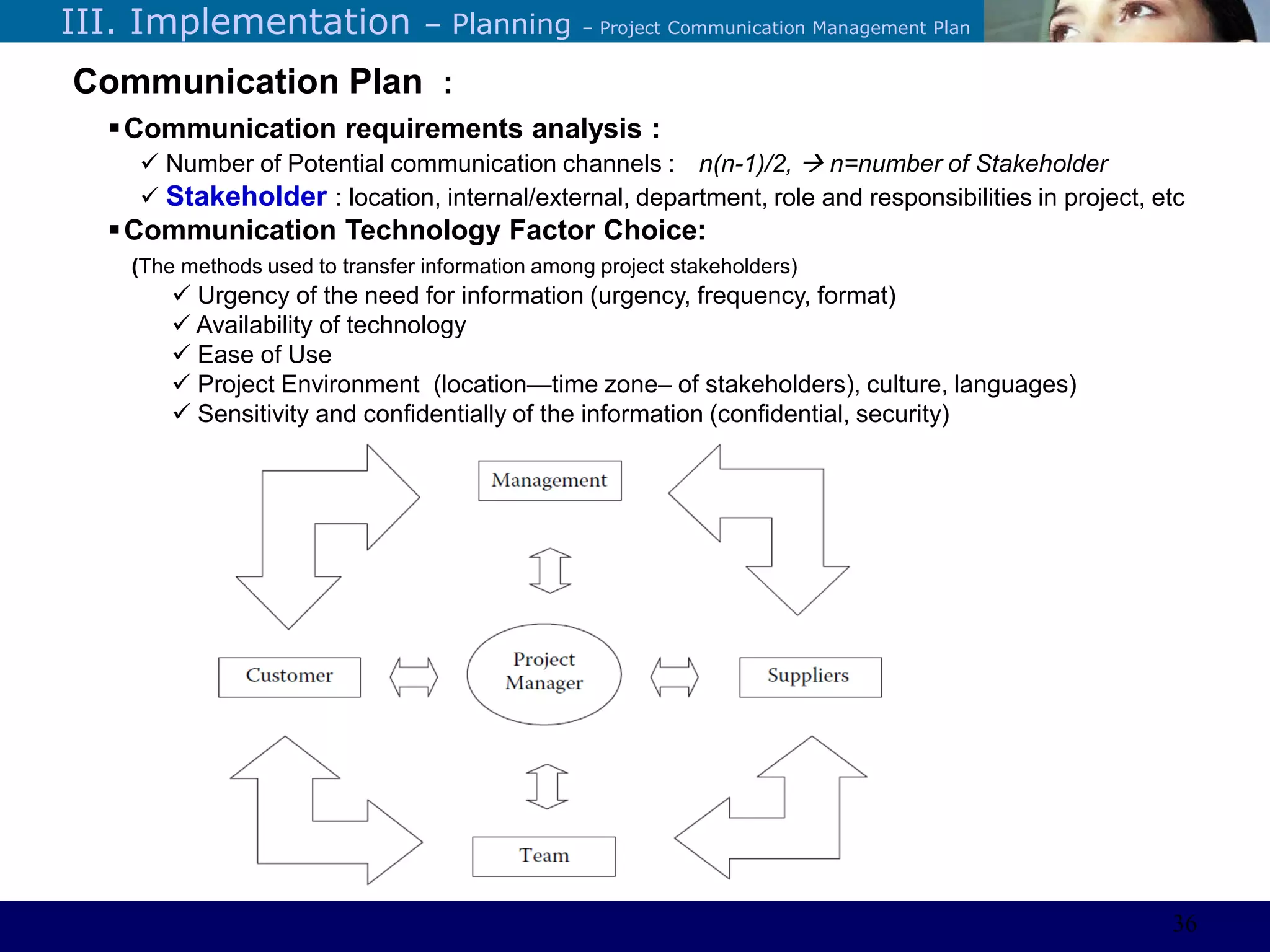

Communication Plan :
Communication requirements analysis :
 Number of Potential communication channels : n(n-1)/2,  n=number of Stakeholder
 Stakeholder : location, internal/external, department, role and responsibilities in project, etc
Communication Technology Factor Choice:
(The methods used to transfer information among project stakeholders)
 Urgency of the need for information (urgency, frequency, format)
 Availability of technology
 Ease of Use
 Project Environment (location—time zone– of stakeholders), culture, languages)
 Sensitivity and confidentially of the information (confidential, security)
36
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – Project Communication Management Plan
Communication Plan : (slide pendukung)
37
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – Project Risk Management Plan

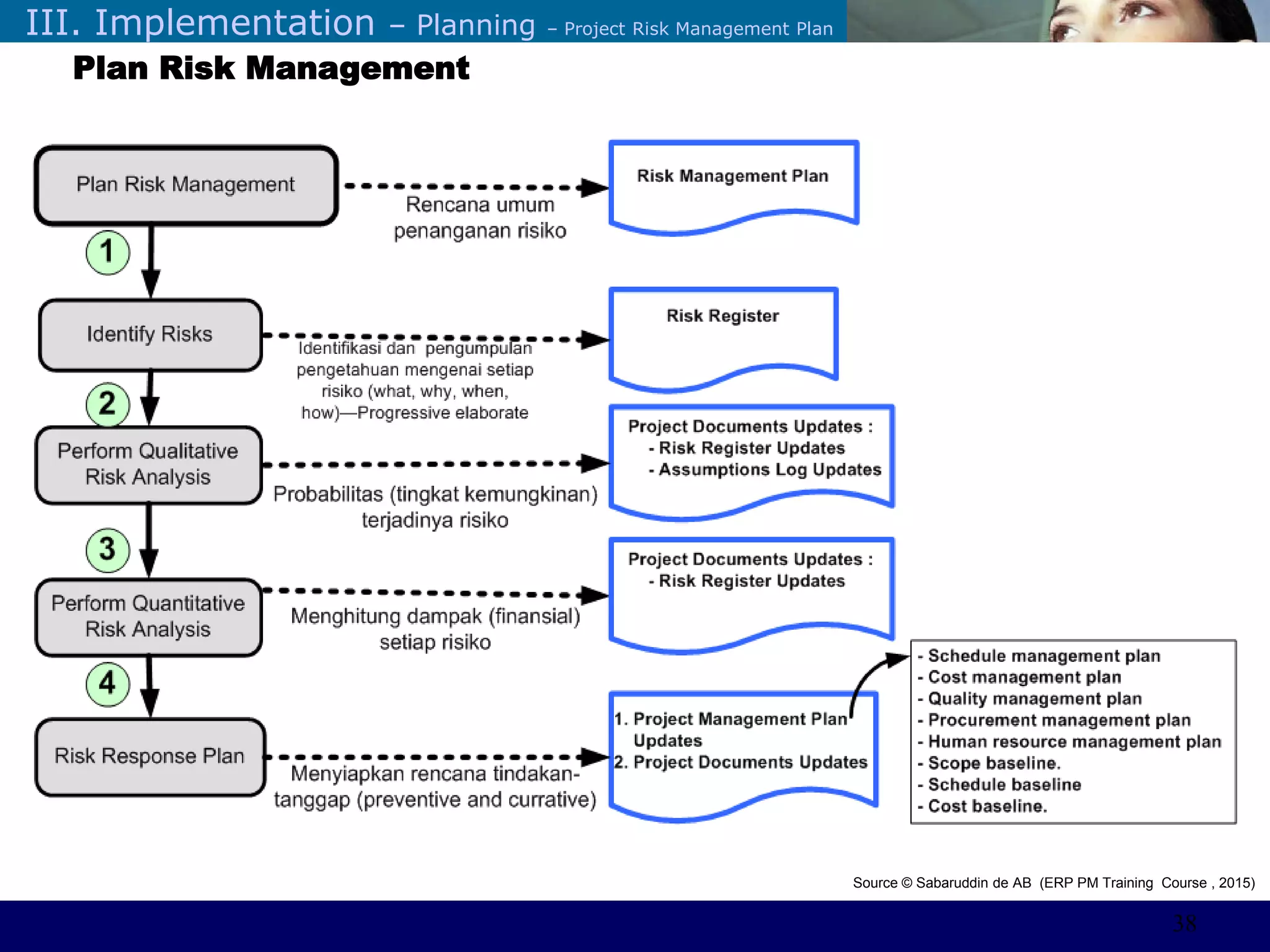

Plan Risk Management
Source © Sabaruddin de AB (ERP PM Training Course , 2015)
38
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – Project Risk Management Plan
Plan Risk Management
What ?
is the process of defining how to conduct risk management activities for a project.
It ensures that the degree, type, and visibility of risk management are commensurate
with both the risks and the importance of the project to the organization.
Definition :
Project risk is an uncertain event or condition that, if it occurs, has a positive or negative
effect on one or more project objectives such as scope, schedule, cost, and quality.
How ?
Disebabkan karena pola penanganan risiko yang memunculkan opportunity untuk
memberikan hasil( results )yang menguntungkan
Note :
 Positive Risk : Opportunity (Exploit, Enhance, Share, Accept)
 Negative Risk : Threats (Avoid, Mitigate, Transfer, Accept)
Source © PMI Guide 5th Ed.
39
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – Project Risk Management Plan

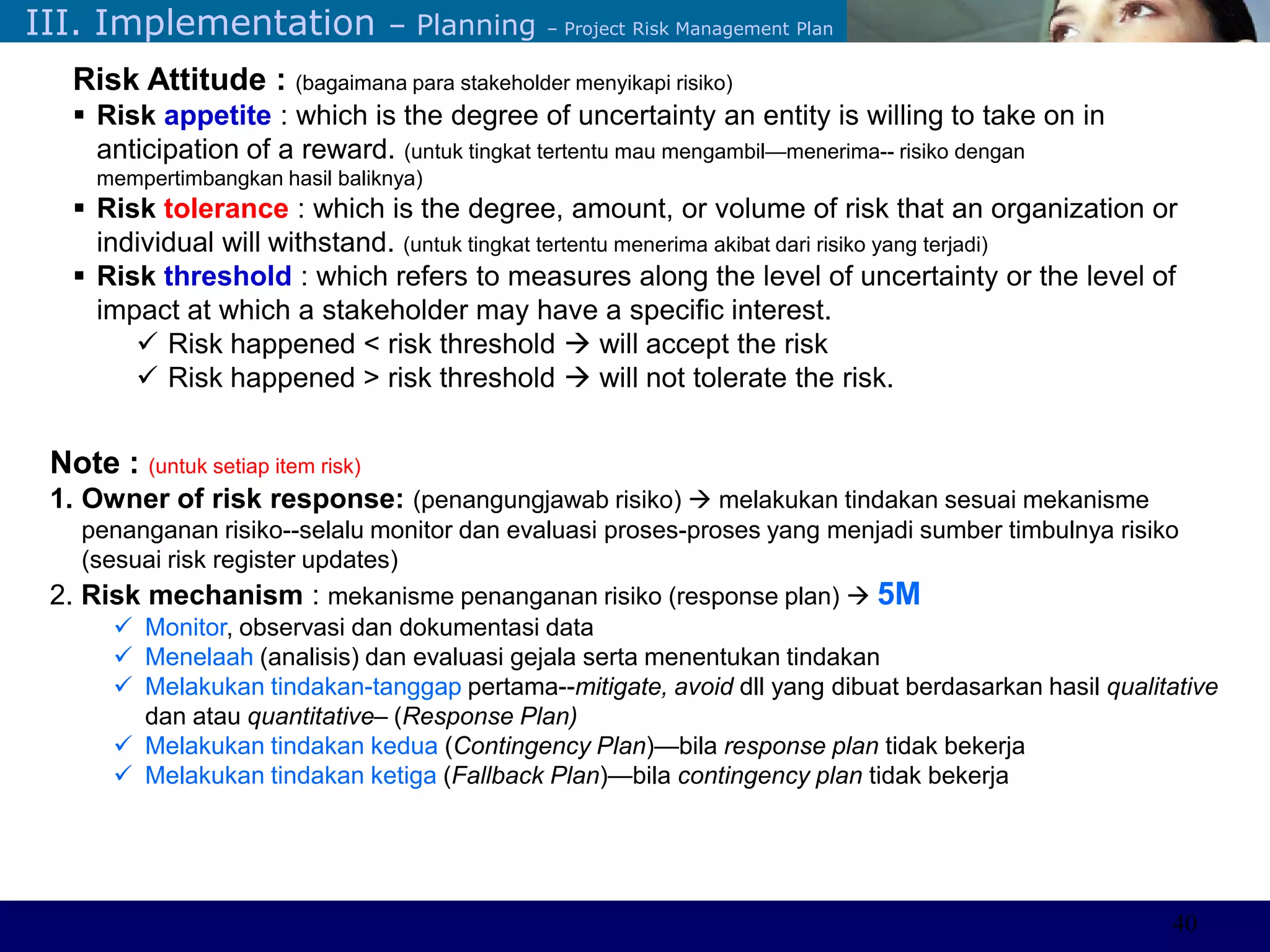

Note : (untuk setiap item risk)
1. Owner of risk response: (penangungjawab risiko)  melakukan tindakan sesuai mekanisme
penanganan risiko--selalu monitor dan evaluasi proses-proses yang menjadi sumber timbulnya risiko
(sesuai risk register updates)
2. Risk mechanism : mekanisme penanganan risiko (response plan)  5M
 Monitor, observasi dan dokumentasi data
 Menelaah (analisis) dan evaluasi gejala serta menentukan tindakan
 Melakukan tindakan-tanggap pertama--mitigate, avoid dll yang dibuat berdasarkan hasil qualitative
dan atau quantitative– (Response Plan)
 Melakukan tindakan kedua (Contingency Plan)—bila response plan tidak bekerja
 Melakukan tindakan ketiga (Fallback Plan)—bila contingency plan tidak bekerja
Risk Attitude : (bagaimana para stakeholder menyikapi risiko)
 Risk appetite : which is the degree of uncertainty an entity is willing to take on in
anticipation of a reward. (untuk tingkat tertentu mau mengambil—menerima-- risiko dengan
mempertimbangkan hasil baliknya)
 Risk tolerance : which is the degree, amount, or volume of risk that an organization or
individual will withstand. (untuk tingkat tertentu menerima akibat dari risiko yang terjadi)
 Risk threshold : which refers to measures along the level of uncertainty or the level of
impact at which a stakeholder may have a specific interest.
 Risk happened < risk threshold  will accept the risk
 Risk happened > risk threshold  will not tolerate the risk.
40
©Sabaruddinde AB

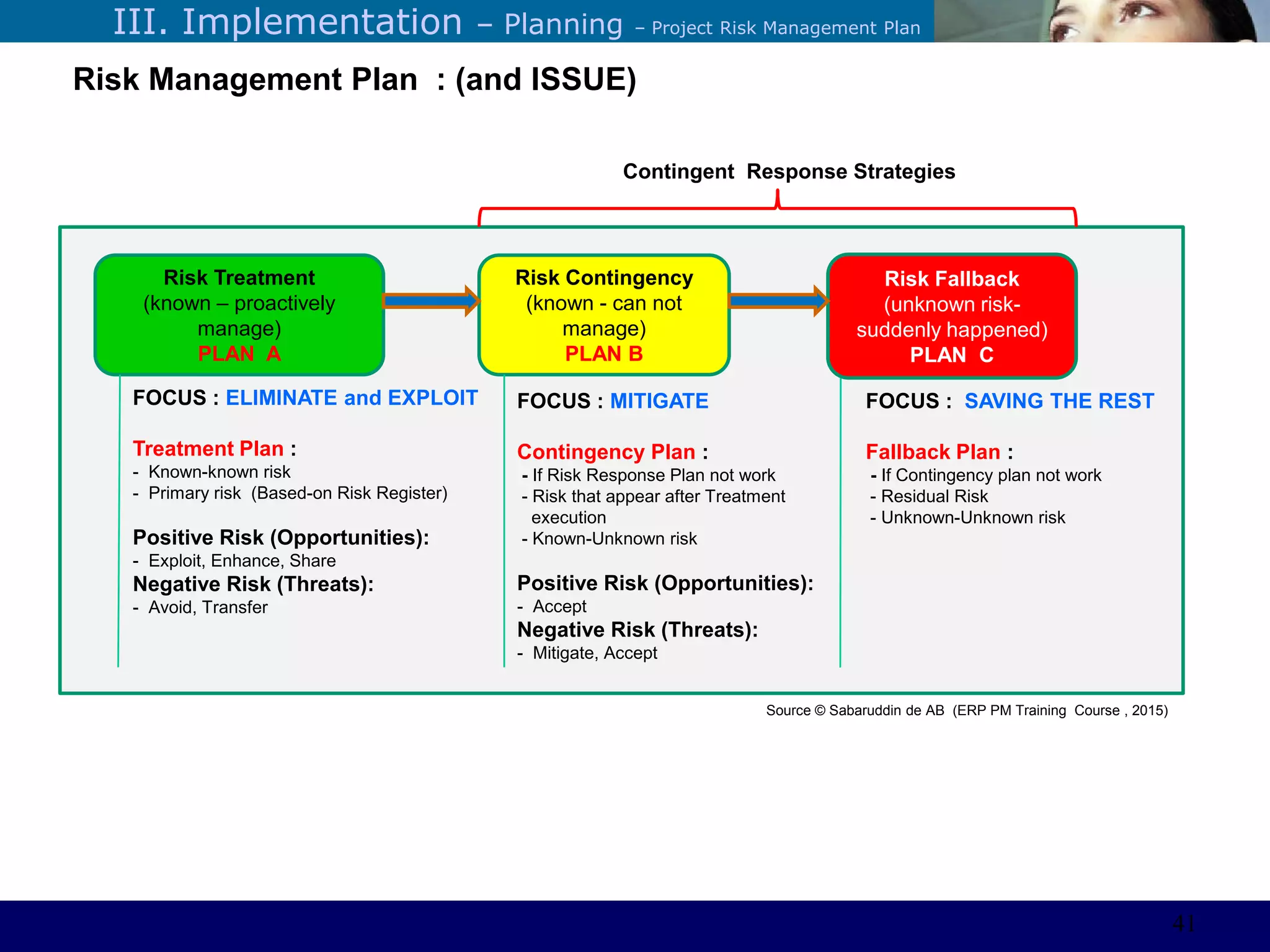

Perlunya IT DepartemenIII. Implementation – Planning – Project Risk Management Plan
Risk Management Plan : (and ISSUE)
Risk Treatment
(known – proactively
manage)
PLAN A
Risk Contingency
(known - can not
manage)
PLAN B
Risk Fallback
(unknown risk-
suddenly happened)
PLAN C
FOCUS : ELIMINATE and EXPLOIT
Treatment Plan :
- Known-known risk
- Primary risk (Based-on Risk Register)
Positive Risk (Opportunities):
- Exploit, Enhance, Share
Negative Risk (Threats):
- Avoid, Transfer
FOCUS : MITIGATE
Contingency Plan :
- If Risk Response Plan not work
- Risk that appear after Treatment
execution
- Known-Unknown risk
Positive Risk (Opportunities):
- Accept
Negative Risk (Threats):
- Mitigate, Accept
FOCUS : SAVING THE REST
Fallback Plan :
- If Contingency plan not work
- Residual Risk
- Unknown-Unknown risk
Source © Sabaruddin de AB (ERP PM Training Course , 2015)
Contingent Response Strategies
41
©Sabaruddinde AB

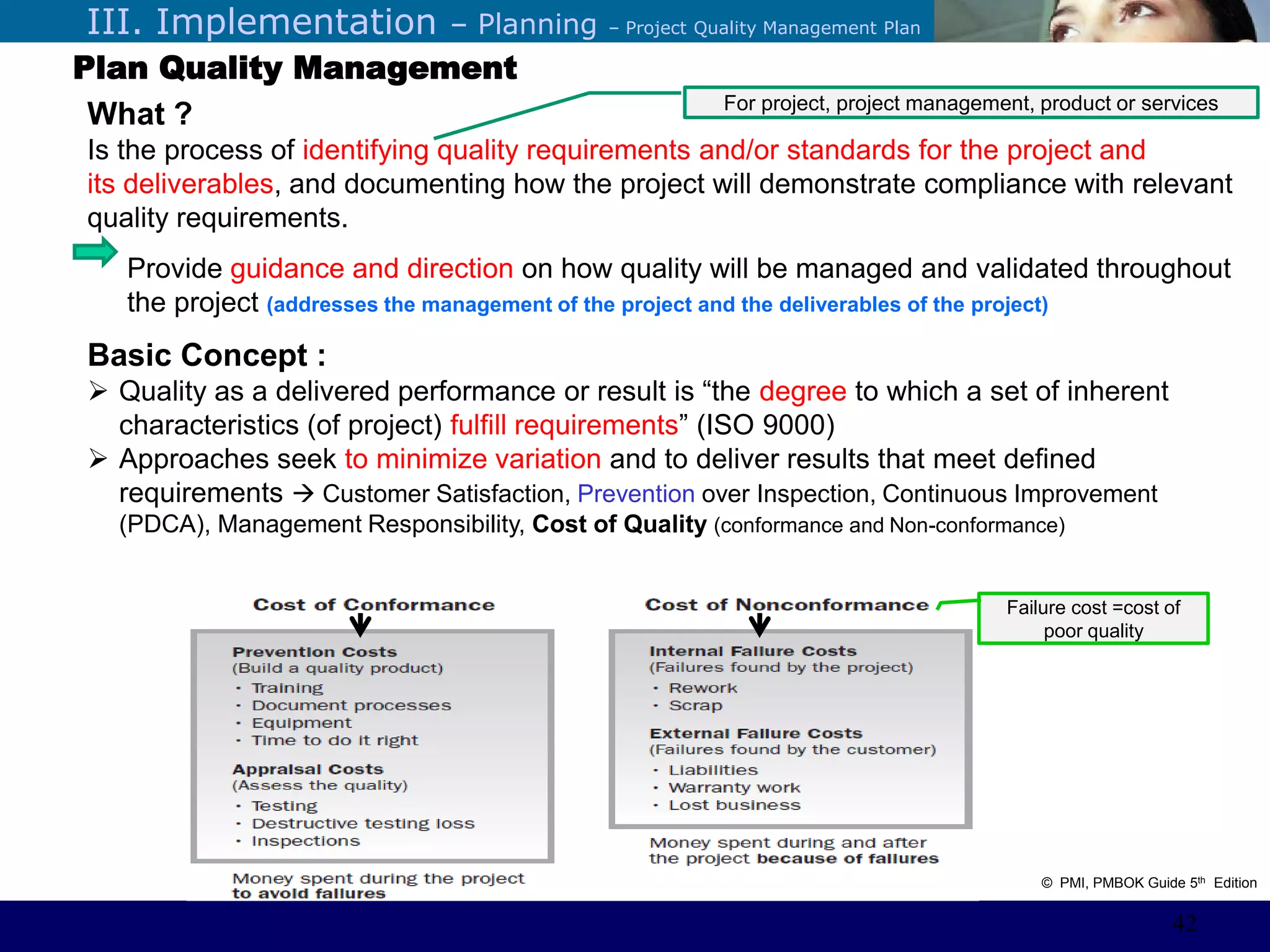

Perlunya IT DepartemenIII. Implementation – Planning – Project Quality Management Plan
Plan Quality Management
What ?
Is the process of identifying quality requirements and/or standards for the project and
its deliverables, and documenting how the project will demonstrate compliance with relevant
quality requirements.
Provide guidance and direction on how quality will be managed and validated throughout
the project (addresses the management of the project and the deliverables of the project)
Basic Concept :
 Quality as a delivered performance or result is ―the degree to which a set of inherent
characteristics (of project) fulfill requirements‖ (ISO 9000)
 Approaches seek to minimize variation and to deliver results that meet defined
requirements  Customer Satisfaction, Prevention over Inspection, Continuous Improvement
(PDCA), Management Responsibility, Cost of Quality (conformance and Non-conformance)
Failure cost =cost of
poor quality
For project, project management, product or services
© PMI, PMBOK Guide 5th Edition
42
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – Project Quality Management Plan
Plan Quality Management

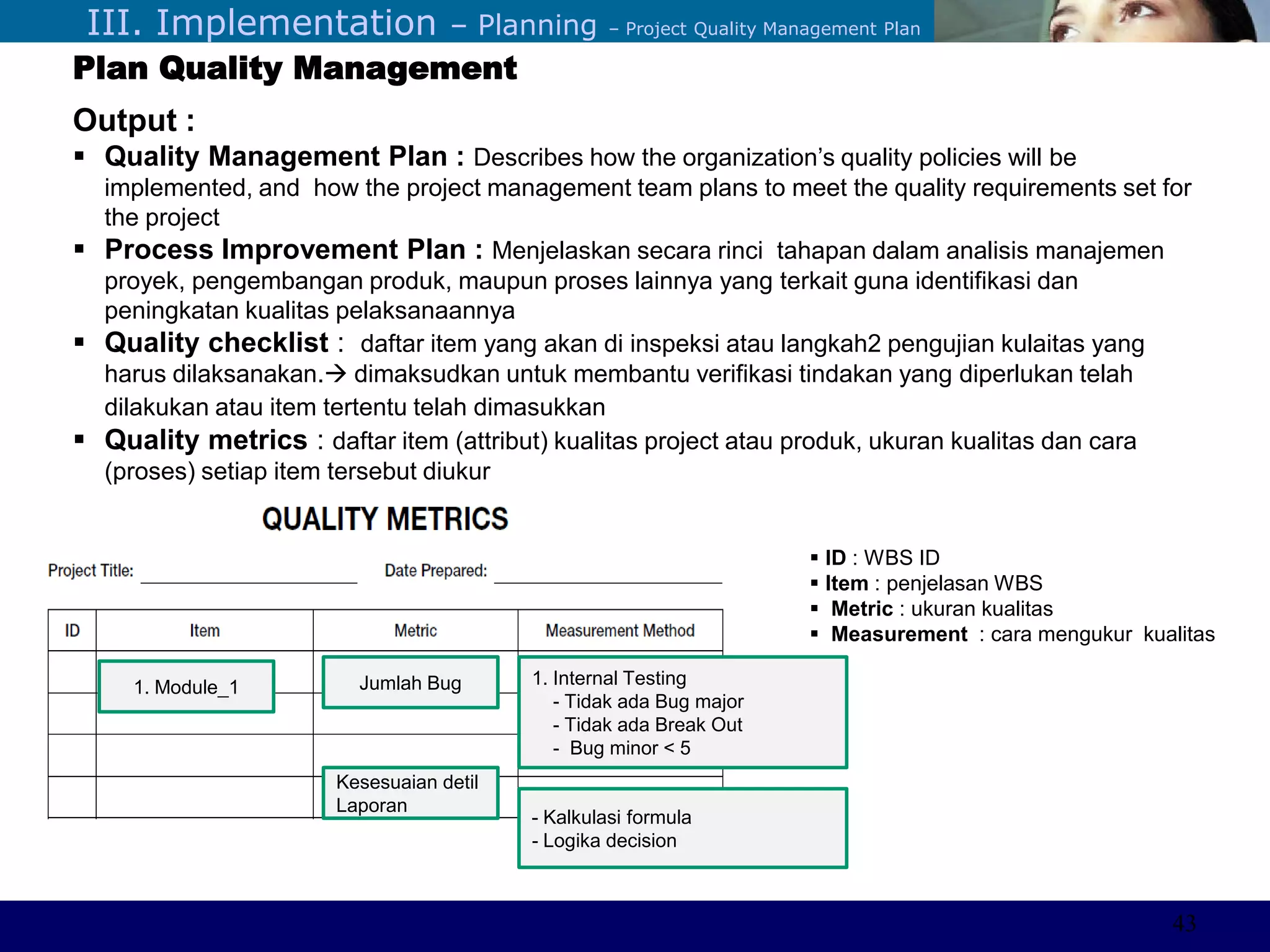

Output :
 Quality Management Plan : Describes how the organization’s quality policies will be
implemented, and how the project management team plans to meet the quality requirements set for
the project
 Process Improvement Plan : Menjelaskan secara rinci tahapan dalam analisis manajemen
proyek, pengembangan produk, maupun proses lainnya yang terkait guna identifikasi dan
peningkatan kualitas pelaksanaannya
 Quality checklist : daftar item yang akan di inspeksi atau langkah2 pengujian kulaitas yang
harus dilaksanakan. dimaksudkan untuk membantu verifikasi tindakan yang diperlukan telah
dilakukan atau item tertentu telah dimasukkan
 Quality metrics : daftar item (attribut) kualitas project atau produk, ukuran kualitas dan cara
(proses) setiap item tersebut diukur
 ID : WBS ID
 Item : penjelasan WBS
 Metric : ukuran kualitas
 Measurement : cara mengukur kualitas
1. Module_1 Jumlah Bug 1. Internal Testing
- Tidak ada Bug major
- Tidak ada Break Out
- Bug minor < 5
Kesesuaian detil
Laporan
- Kalkulasi formula
- Logika decision
43
©Sabaruddinde AB

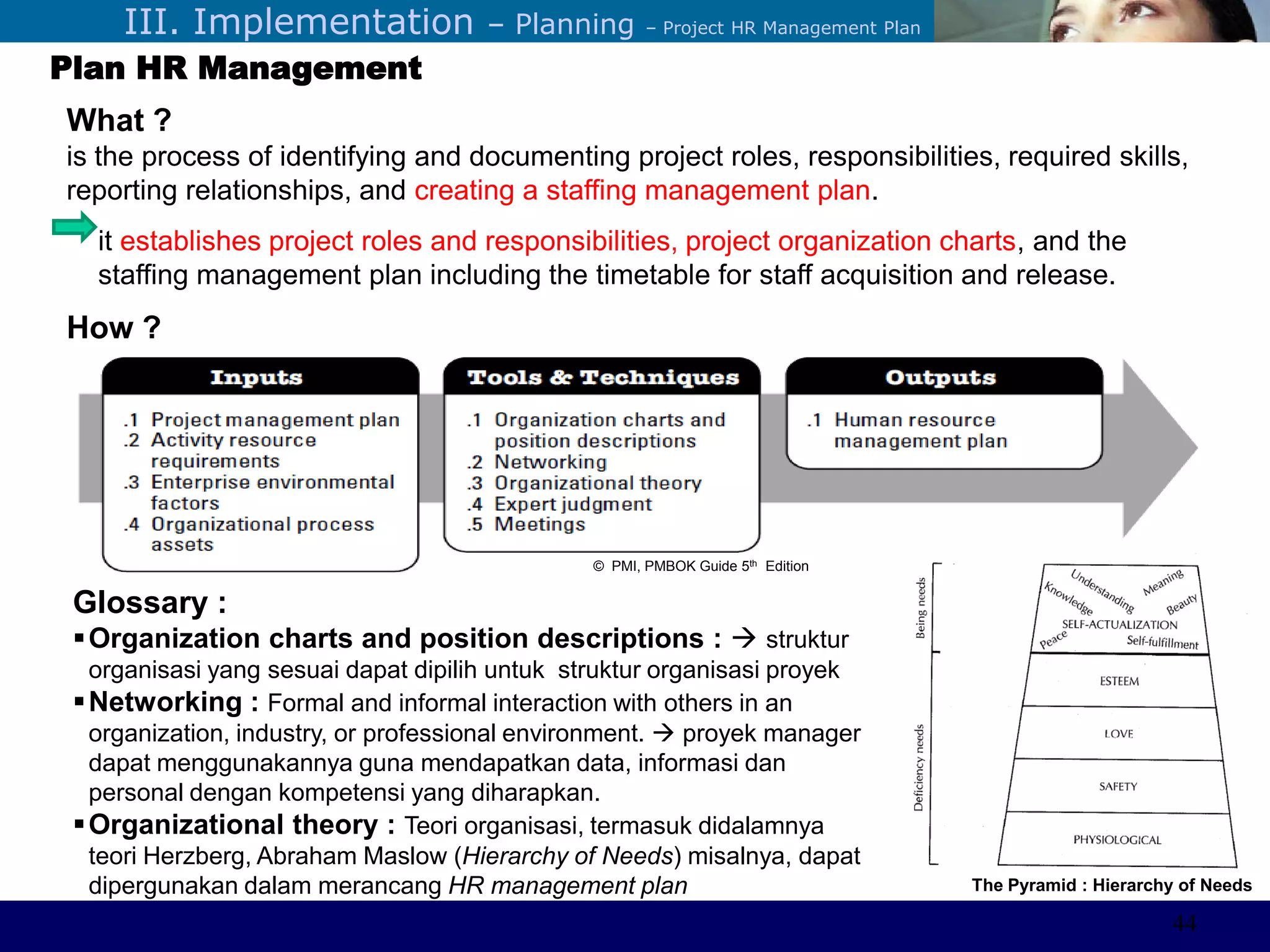

Perlunya IT DepartemenIII. Implementation – Planning – Project HR Management Plan
What ?
is the process of identifying and documenting project roles, responsibilities, required skills,
reporting relationships, and creating a staffing management plan.
it establishes project roles and responsibilities, project organization charts, and the
staffing management plan including the timetable for staff acquisition and release.
How ?
Glossary :
Organization charts and position descriptions :  struktur
organisasi yang sesuai dapat dipilih untuk struktur organisasi proyek
Networking : Formal and informal interaction with others in an
organization, industry, or professional environment.  proyek manager
dapat menggunakannya guna mendapatkan data, informasi dan
personal dengan kompetensi yang diharapkan.
Organizational theory : Teori organisasi, termasuk didalamnya
teori Herzberg, Abraham Maslow (Hierarchy of Needs) misalnya, dapat
dipergunakan dalam merancang HR management plan The Pyramid : Hierarchy of Needs
Plan HR Management
© PMI, PMBOK Guide 5th Edition
44
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – Project HR Management Plan.

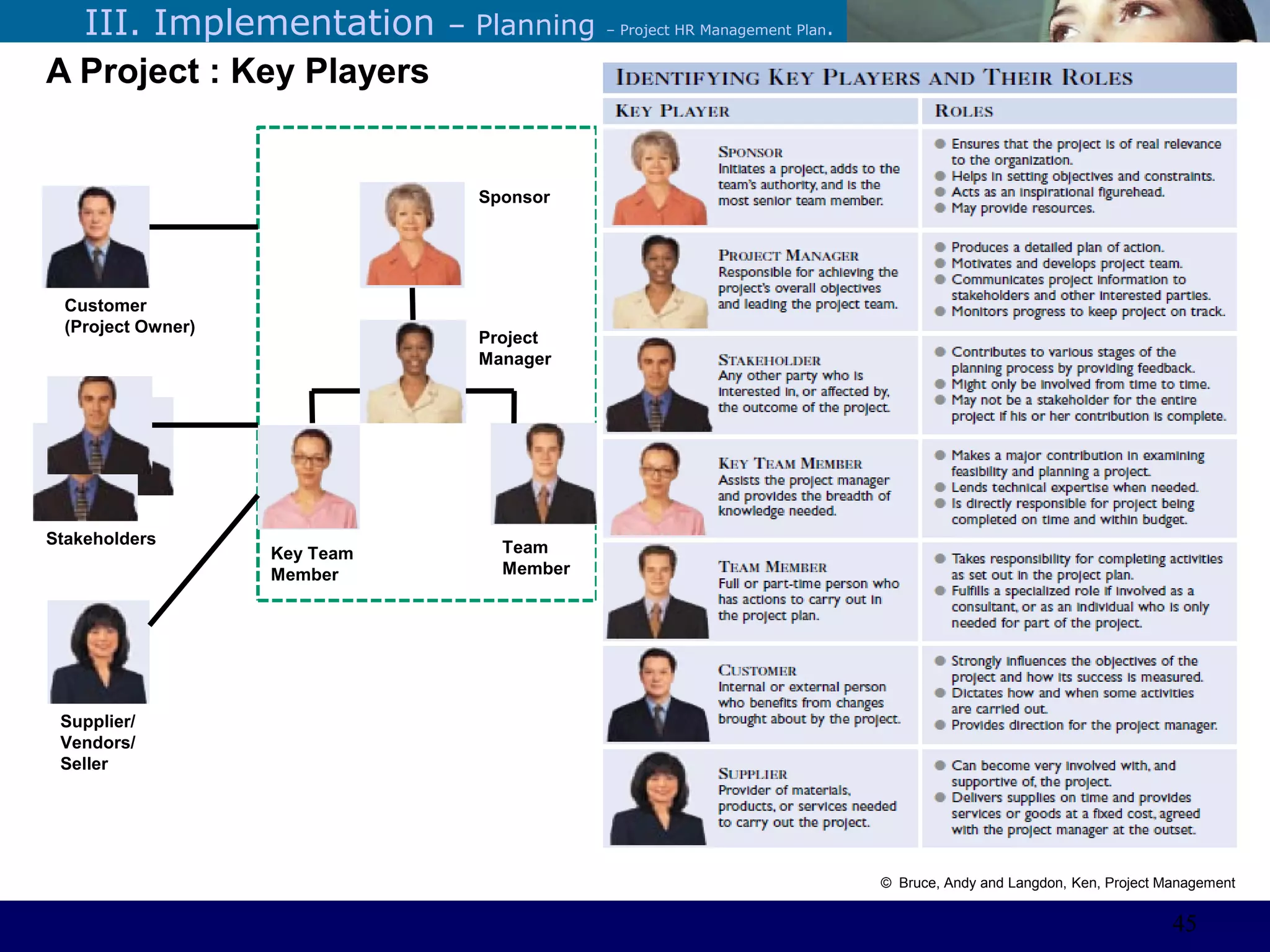

A Project : Key Players
Customer
(Project Owner)
Stakeholders
Supplier/
Vendors/
Seller
Sponsor
Project
Manager
Key Team
Member
Team
Member
© Bruce, Andy and Langdon, Ken, Project Management
45
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – Project HR Management Plan

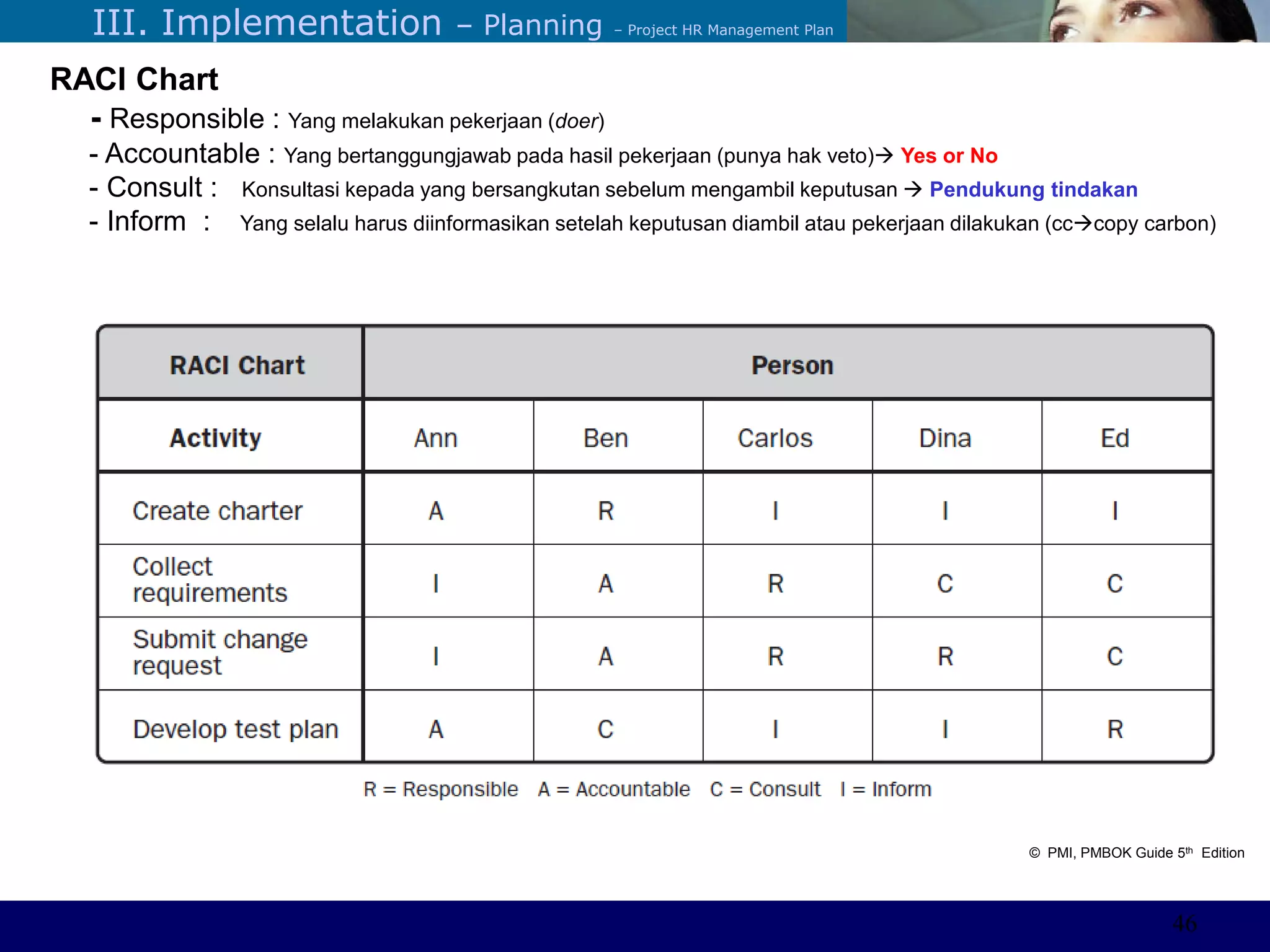

RACI Chart
- Responsible : Yang melakukan pekerjaan (doer)
- Accountable : Yang bertanggungjawab pada hasil pekerjaan (punya hak veto) Yes or No
- Consult : Konsultasi kepada yang bersangkutan sebelum mengambil keputusan  Pendukung tindakan
- Inform : Yang selalu harus diinformasikan setelah keputusan diambil atau pekerjaan dilakukan (cccopy carbon)
© PMI, PMBOK Guide 5th Edition
46
©Sabaruddinde AB

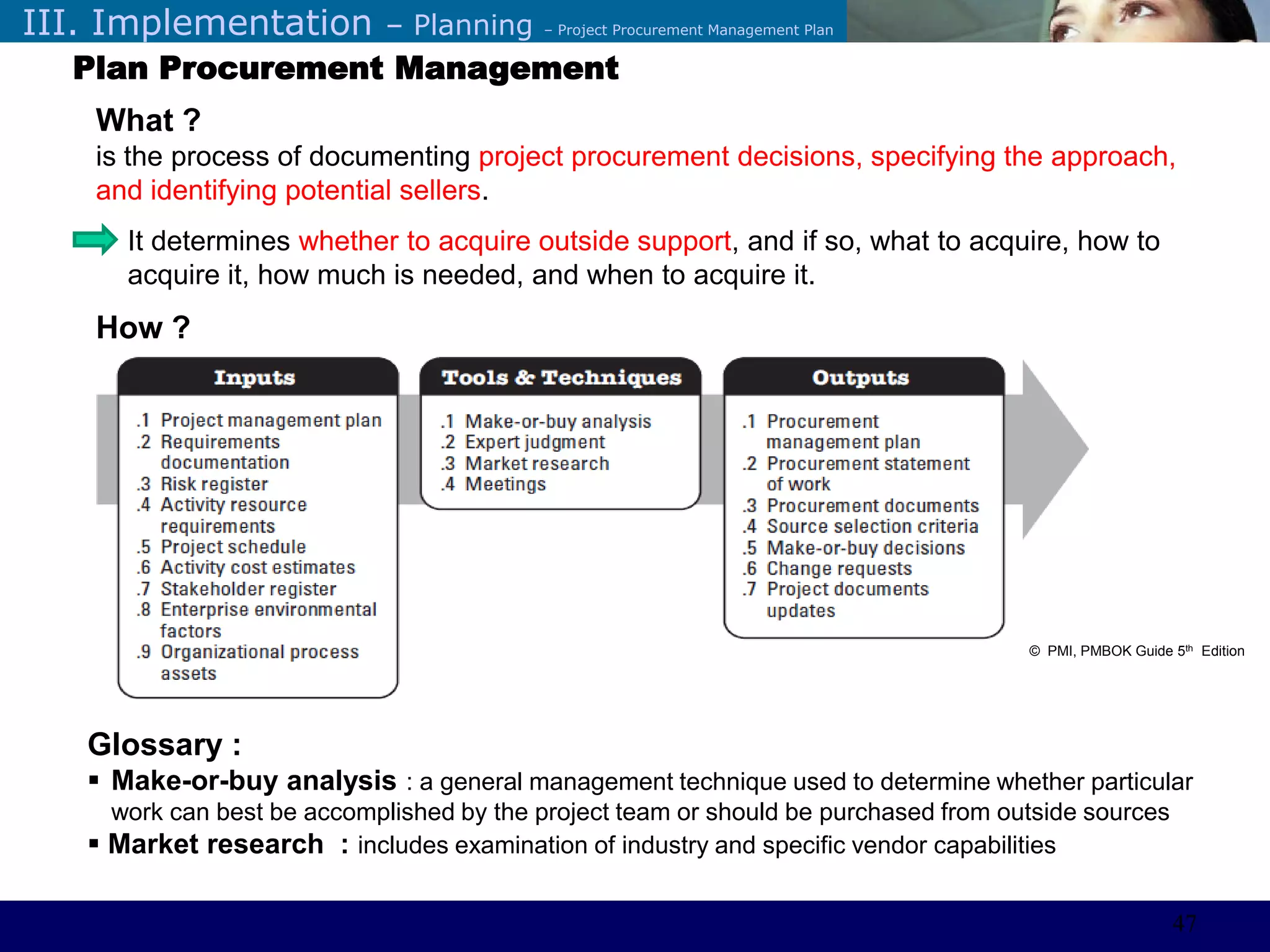

Perlunya IT DepartemenIII. Implementation – Planning – Project Procurement Management Plan
Plan Procurement Management
What ?
is the process of documenting project procurement decisions, specifying the approach,
and identifying potential sellers.
It determines whether to acquire outside support, and if so, what to acquire, how to
acquire it, how much is needed, and when to acquire it.
How ?
Glossary :
 Make-or-buy analysis : a general management technique used to determine whether particular
work can best be accomplished by the project team or should be purchased from outside sources
 Market research : includes examination of industry and specific vendor capabilities
© PMI, PMBOK Guide 5th Edition
47
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – Project Stakeholder Management Plan

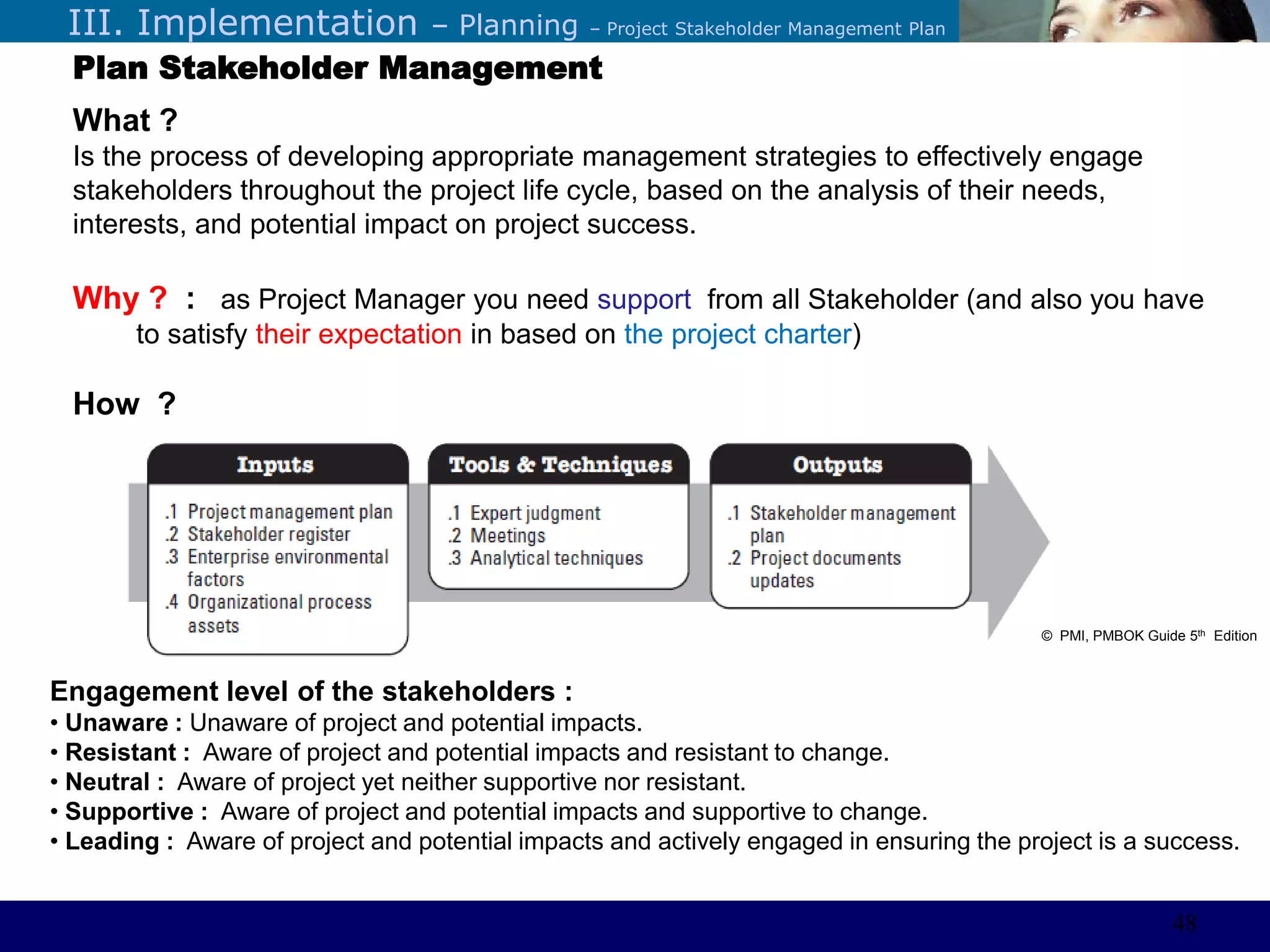

Plan Stakeholder Management
What ?
Is the process of developing appropriate management strategies to effectively engage
stakeholders throughout the project life cycle, based on the analysis of their needs,
interests, and potential impact on project success.
Why ? : as Project Manager you need support from all Stakeholder (and also you have
to satisfy their expectation in based on the project charter)
How ?
Engagement level of the stakeholders :
• Unaware : Unaware of project and potential impacts.
• Resistant : Aware of project and potential impacts and resistant to change.
• Neutral : Aware of project yet neither supportive nor resistant.
• Supportive : Aware of project and potential impacts and supportive to change.
• Leading : Aware of project and potential impacts and actively engaged in ensuring the project is a success.
© PMI, PMBOK Guide 5th Edition
48
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – Project Stakeholder Management Plan

Stakeholder Management Plan
Stakeholder engagement matrix :
Aware
Unaware of project and potential impacts
49
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – ERP Customization Process Management

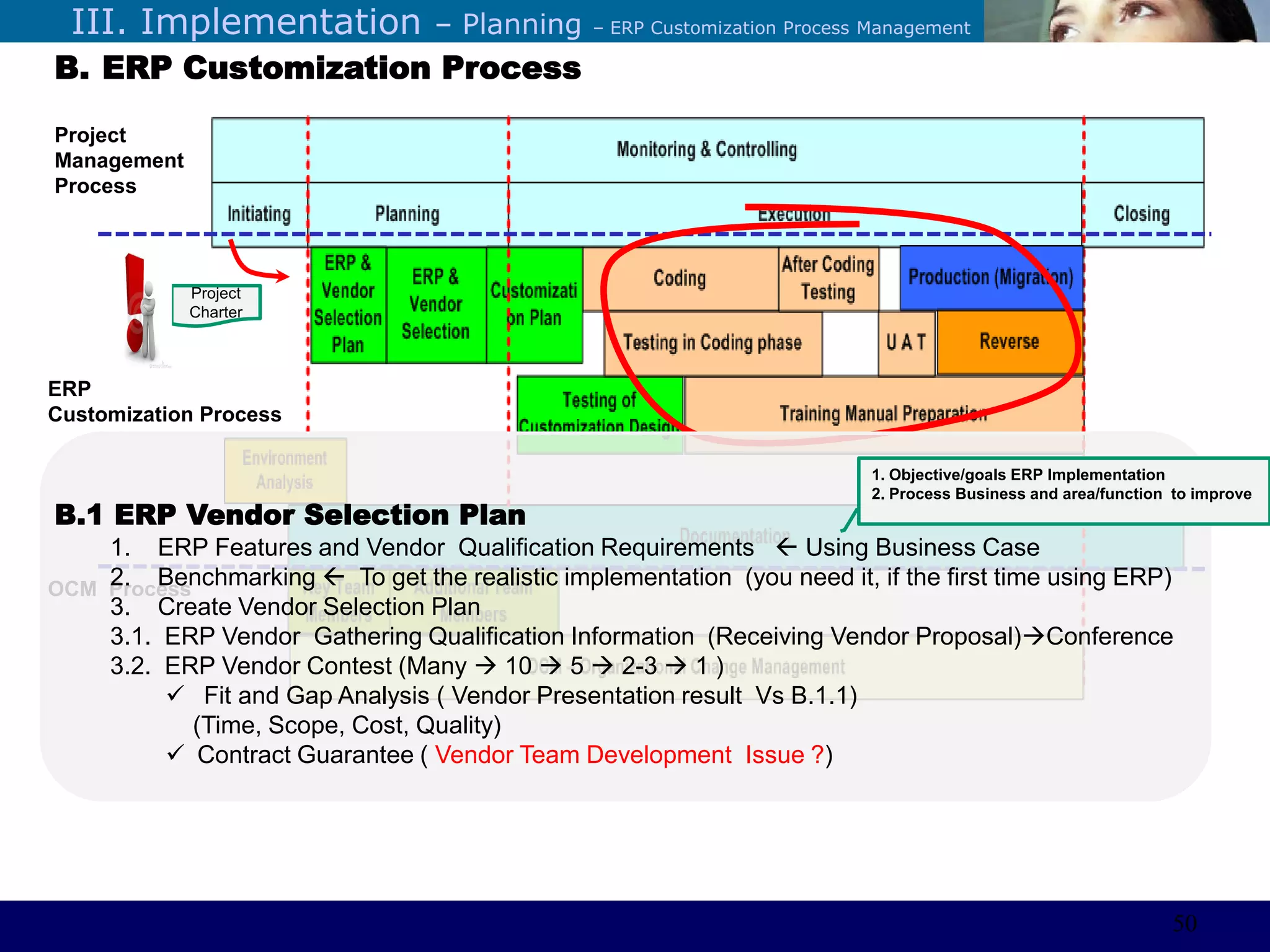

B. ERP Customization Process
Project
Management
Process
ERP
Customization Process
OCM Process
B.1 ERP Vendor Selection Plan
1. ERP Features and Vendor Qualification Requirements  Using Business Case
2. Benchmarking  To get the realistic implementation (you need it, if the first time using ERP)
3. Create Vendor Selection Plan
3.1. ERP Vendor Gathering Qualification Information (Receiving Vendor Proposal)Conference
3.2. ERP Vendor Contest (Many  10  5  2-3  1 )
 Fit and Gap Analysis ( Vendor Presentation result Vs B.1.1)
(Time, Scope, Cost, Quality)
 Contract Guarantee ( Vendor Team Development Issue ?)
Project
Charter
1. Objective/goals ERP Implementation
2. Process Business and area/function to improve
50
©Sabaruddinde AB

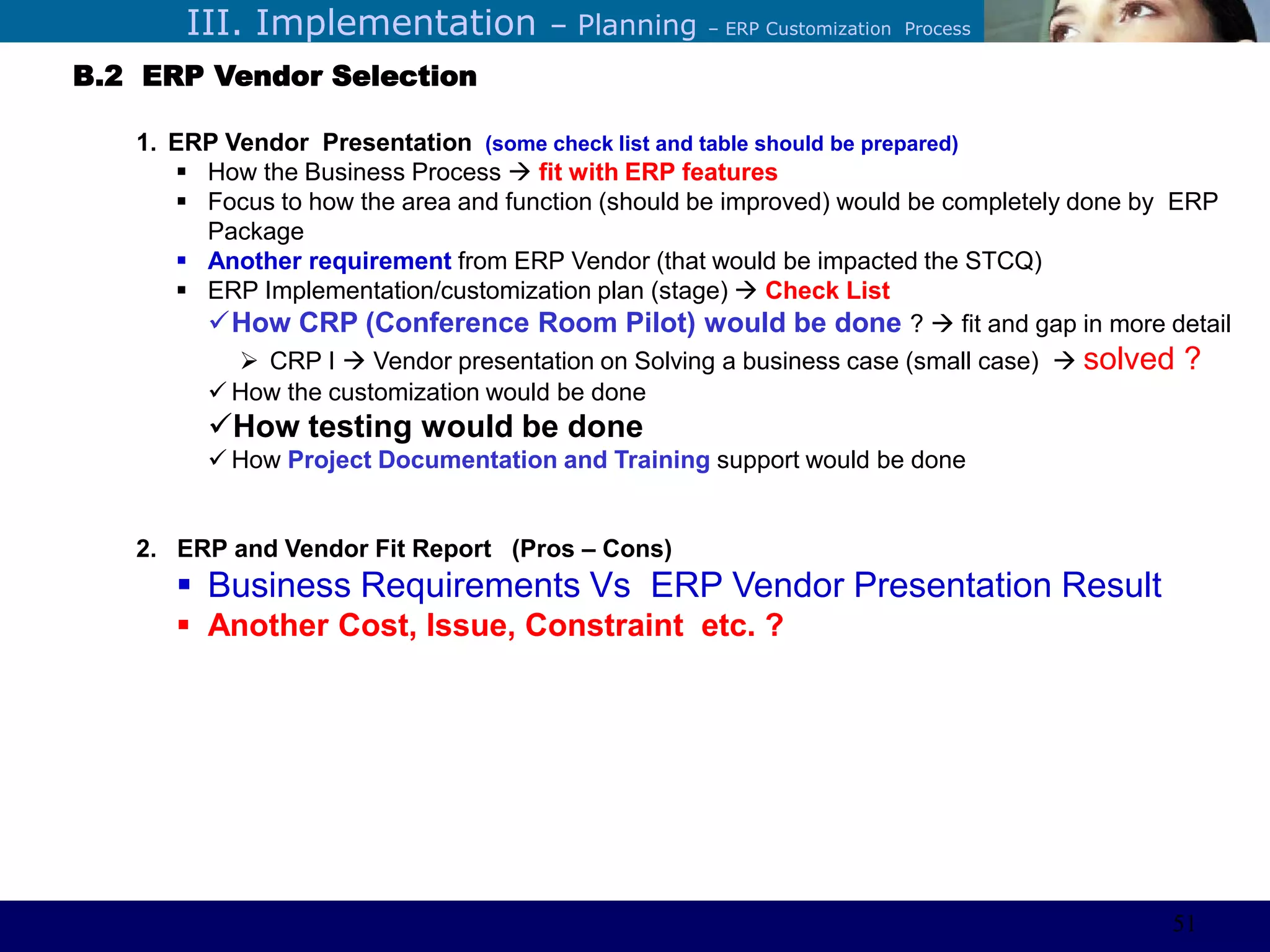

Perlunya IT DepartemenIII. Implementation – Planning – ERP Customization Process
B.2 ERP Vendor Selection
1. ERP Vendor Presentation (some check list and table should be prepared)
 How the Business Process  fit with ERP features
 Focus to how the area and function (should be improved) would be completely done by ERP
Package
 Another requirement from ERP Vendor (that would be impacted the STCQ)
 ERP Implementation/customization plan (stage)  Check List
How CRP (Conference Room Pilot) would be done ?  fit and gap in more detail
 CRP I  Vendor presentation on Solving a business case (small case)  solved ?
 How the customization would be done
How testing would be done
 How Project Documentation and Training support would be done
2. ERP and Vendor Fit Report (Pros – Cons)
 Business Requirements Vs ERP Vendor Presentation Result
 Another Cost, Issue, Constraint etc. ?
51
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Planning – Organizational Change Management

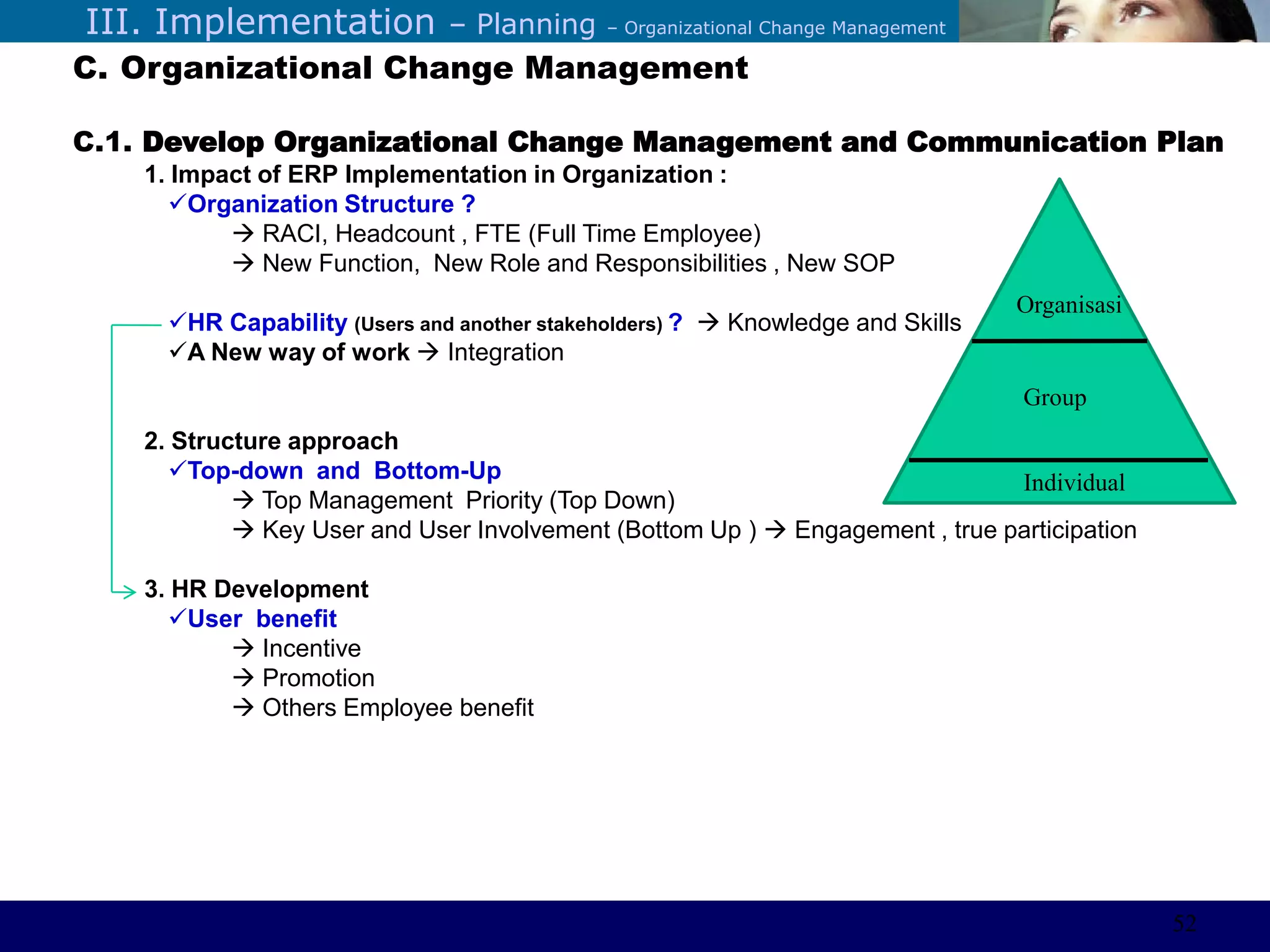

C. Organizational Change Management
C.1. Develop Organizational Change Management and Communication Plan
1. Impact of ERP Implementation in Organization :
Organization Structure ?
 RACI, Headcount , FTE (Full Time Employee)
 New Function, New Role and Responsibilities , New SOP
HR Capability (Users and another stakeholders) ?  Knowledge and Skills
A New way of work  Integration
2. Structure approach
Top-down and Bottom-Up
 Top Management Priority (Top Down)
 Key User and User Involvement (Bottom Up )  Engagement , true participation
3. HR Development
User benefit
 Incentive
 Promotion
 Others Employee benefit
Individual
Group
Organisasi
52
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation -Planning – Organizational Change Management
C.2 Executing the OCM and Communication Plan
1. Resistance
 Elizabeth Kubler-Ross Change Curve (On Death and Dying, Macmillan, NY, 1969)
53
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation-Planning – Organizational Change Management

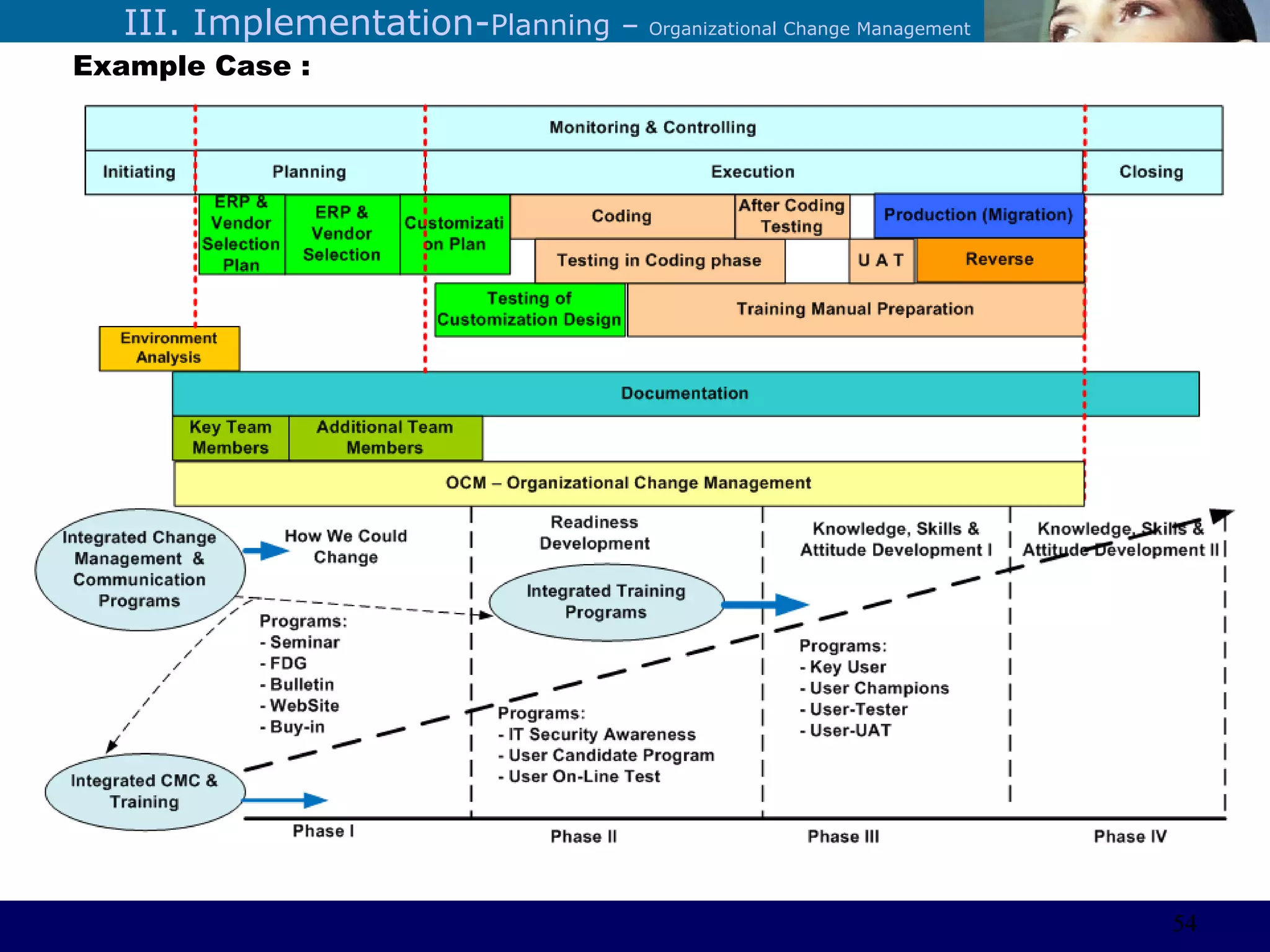

Example Case :
54
©Sabaruddinde AB
Perlunya IT Departemen.
55
©Sabaruddinde AB
Perlunya IT DepartemenProject Trouble?
Day to day in Project Executing….
Source : Internet (www)
56
©Sabaruddinde AB

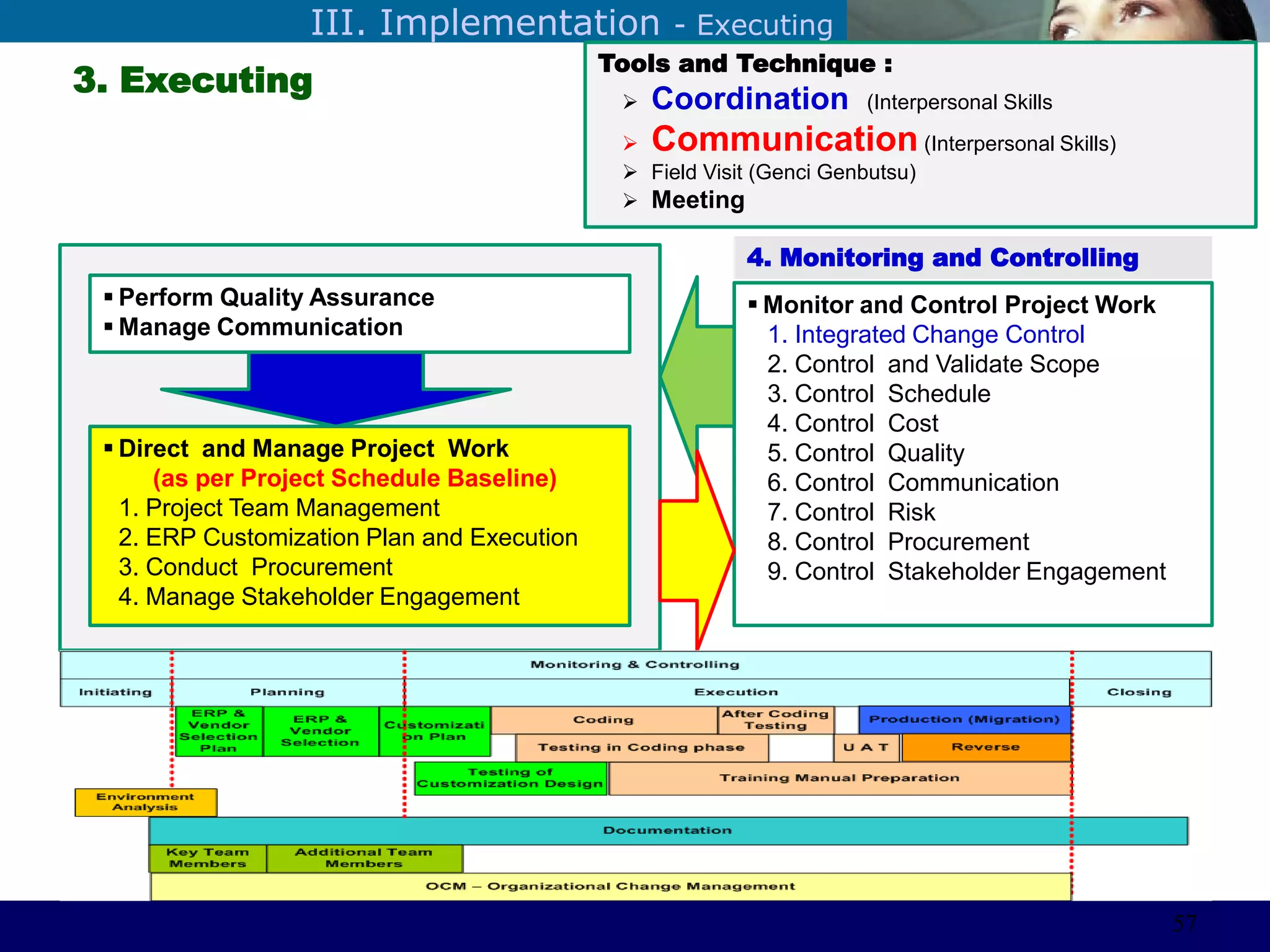

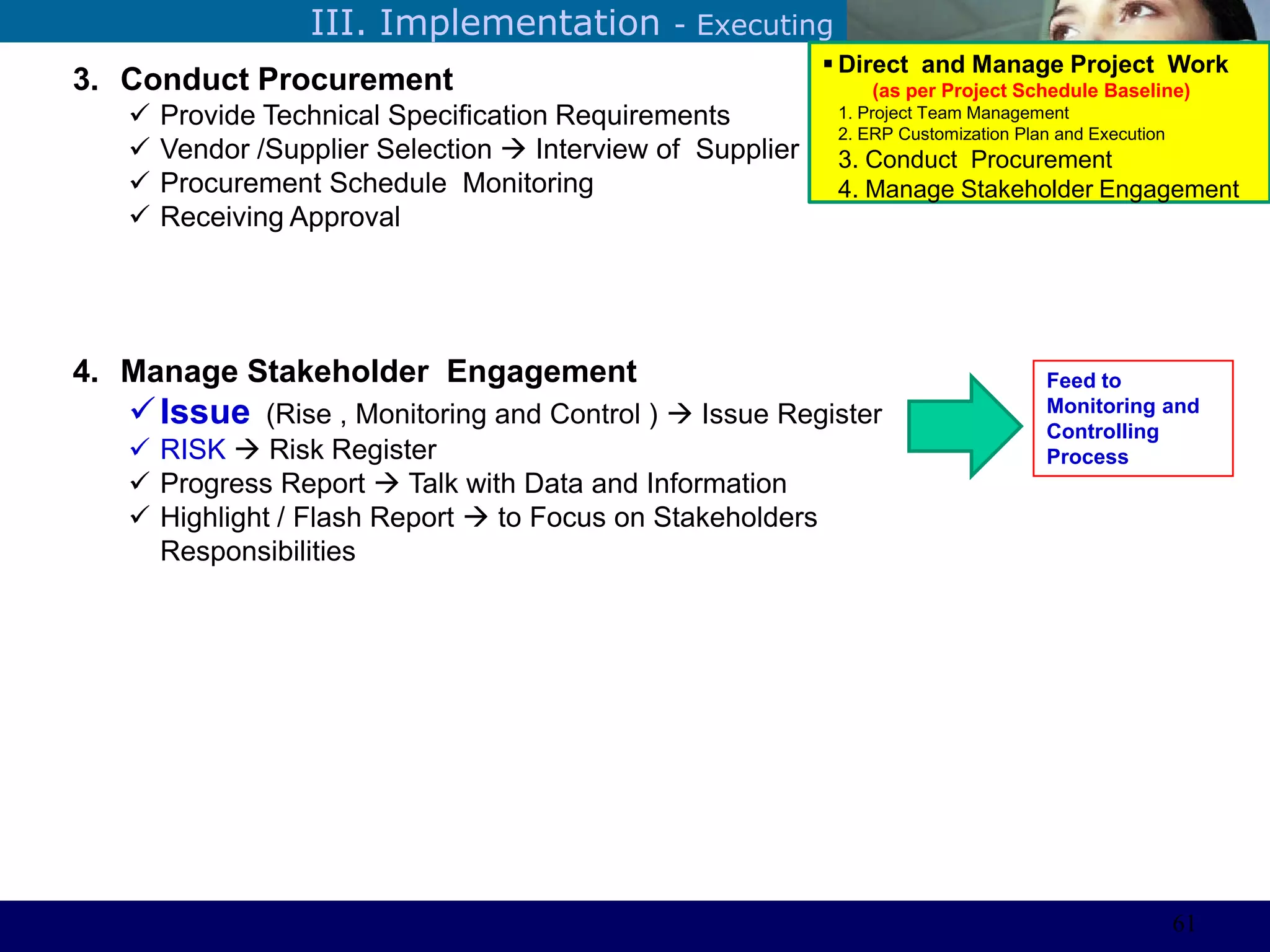

3. Executing
Perlunya IT DepartemenIII. Implementation - Executing
Tools and Technique :
 Coordination (Interpersonal Skills
 Communication (Interpersonal Skills)
 Field Visit (Genci Genbutsu)
 Meeting
 Direct and Manage Project Work
(as per Project Schedule Baseline)
1. Project Team Management

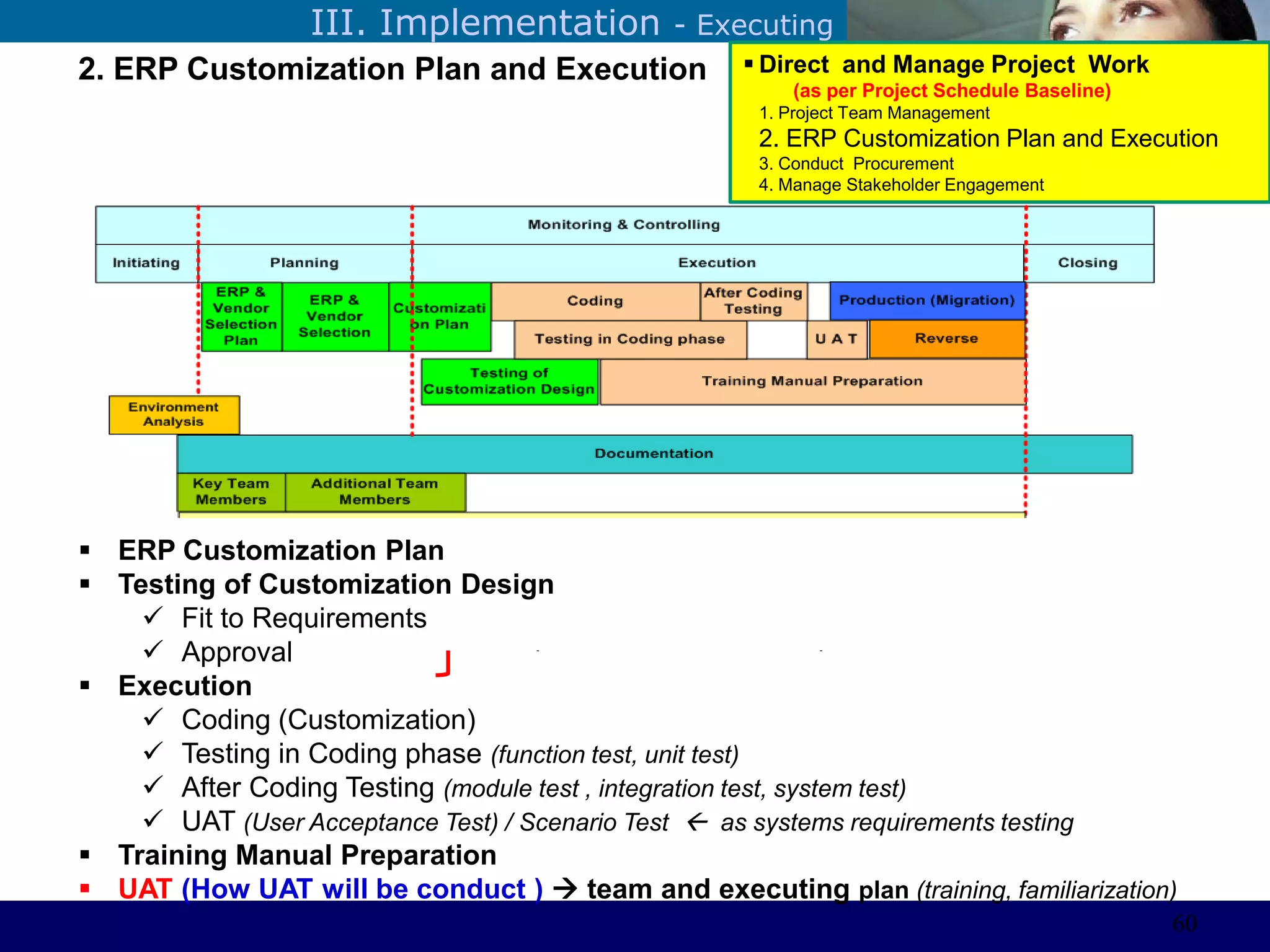

2. ERP Customization Plan and Execution
3. Conduct Procurement
4. Manage Stakeholder Engagement
 Perform Quality Assurance
 Manage Communication
 Monitor and Control Project Work
1. Integrated Change Control
2. Control and Validate Scope
3. Control Schedule
4. Control Cost
5. Control Quality
6. Control Communication
7. Control Risk
8. Control Procurement
9. Control Stakeholder Engagement
4. Monitoring and Controlling
57
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Executing – Project Team Management
1. Project Team Management
 Work Management
 Daily Activity
 Team Performance Assessment
 Work (project schedule) Monitoring and Controlling
 Daily Activity Report
 Work Package Progress Report (Weekly and Monthly)
 Team Performance Report (Monthly)
 Schedule Realization (Plan Vs Actual)
 Develop Project Team Performing (multi-style approach)
 Observation and Assessment
 Coaching
 Short – Training
Tools and Technique :
 Interpersonal Skills
 Observation
 genci genbutsu
 Direct and Manage Project Work
(as per Project Schedule Baseline)
1. Project Team Management
2. ERP Customization Plan and Execution
3. Conduct Procurement
4. Manage Stakeholder Engagement
58
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation – Executing – Project Team Performance
Develop Project Team Performing
 Performing Tools
Coaching
Short-Training
“Fergusson hair dryer”
“Mourinho motivation style”
Active (+)
Passive (-)
Forming
Performing(+)
Norming
Storming (-)
Adjourning
TeamWorkPerformance
Time
Information and Communication :
- Intensive Communication
- Motivation
- Individual approach
- Trust Building
- Engagement Managing and control Work :
- Target List
- Full Support
- Feed Back
“Mourinho motivation style”
Tools and Technique :
 Coaching
 Short-Training
 Treatment (Ferguson vs Mourinho)
“Ferguson hair dryer”
59
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation - Executing
2. ERP Customization Plan and Execution  Direct and Manage Project Work
(as per Project Schedule Baseline)
1. Project Team Management
2. ERP Customization Plan and Execution
3. Conduct Procurement
4. Manage Stakeholder Engagement
CRP (Conference Room Pilot ) – II, …
60
 ERP Customization Plan
 Testing of Customization Design
 Fit to Requirements
 Approval
 Execution
 Coding (Customization)
 Testing in Coding phase (function test, unit test)
 After Coding Testing (module test , integration test, system test)
 UAT (User Acceptance Test) / Scenario Test  as systems requirements testing
 Training Manual Preparation
 UAT (How UAT will be conduct )  team and executing plan (training, familiarization)
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation - Executing
3. Conduct Procurement
 Provide Technical Specification Requirements
 Vendor /Supplier Selection  Interview of Supplier Performance
 Procurement Schedule Monitoring
 Receiving Approval
4. Manage Stakeholder Engagement
Issue (Rise , Monitoring and Control )  Issue Register
 RISK  Risk Register
 Progress Report  Talk with Data and Information
 Highlight / Flash Report  to Focus on Stakeholders
Responsibilities
 Direct and Manage Project Work
(as per Project Schedule Baseline)
1. Project Team Management
2. ERP Customization Plan and Execution
3. Conduct Procurement
4. Manage Stakeholder Engagement
Feed to
Monitoring and
Controlling
Process
61
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation - Monitoring and Controlling – Road Map
62
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation - Monitoring and Controlling – Approach
Project
Charter
63
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation- Monitoring and Controlling - Action

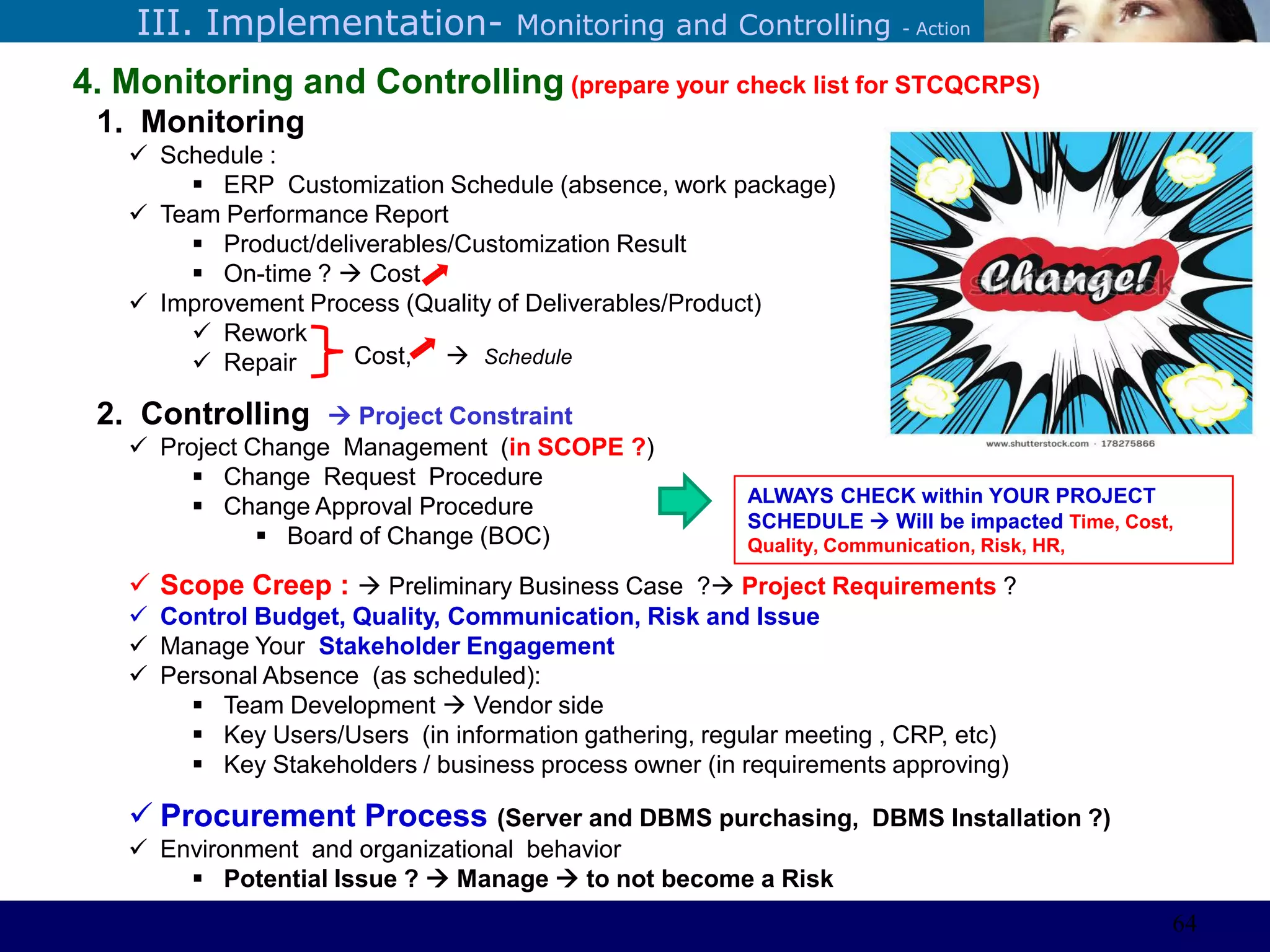

4. Monitoring and Controlling (prepare your check list for STCQCRPS)
1. Monitoring
 Schedule :
 ERP Customization Schedule (absence, work package)
 Team Performance Report
 Product/deliverables/Customization Result
 On-time ?  Cost
 Improvement Process (Quality of Deliverables/Product)
 Rework
 Repair
2. Controlling  Project Constraint
 Project Change Management (in SCOPE ?)
 Change Request Procedure
 Change Approval Procedure
 Board of Change (BOC)
 Scope Creep :  Preliminary Business Case ? Project Requirements ?
 Control Budget, Quality, Communication, Risk and Issue
 Manage Your Stakeholder Engagement
 Personal Absence (as scheduled):
 Team Development  Vendor side
 Key Users/Users (in information gathering, regular meeting , CRP, etc)
 Key Stakeholders / business process owner (in requirements approving)
 Procurement Process (Server and DBMS purchasing, DBMS Installation ?)
 Environment and organizational behavior
 Potential Issue ?  Manage  to not become a Risk
ALWAYS CHECK within YOUR PROJECT
SCHEDULE  Will be impacted Time, Cost,
Quality, Communication, Risk, HR,
Cost,  Schedule
64
©Sabaruddinde AB
Perlunya IT DepartemenIII. Implementation - Closing
5. Closing
1. Document Preparation
 Project Management Document
 Product Life Cycle Document
 OCM Document
 Lesson-Learned Document
 Opportunity Proposal (by Project Manager)
2. Project Closing
 Project Closing Meeting
 Procurement (any issue about payment ?)
 Project Team meeting
 Internal Team  Promotion ?
65
©Sabaruddinde AB

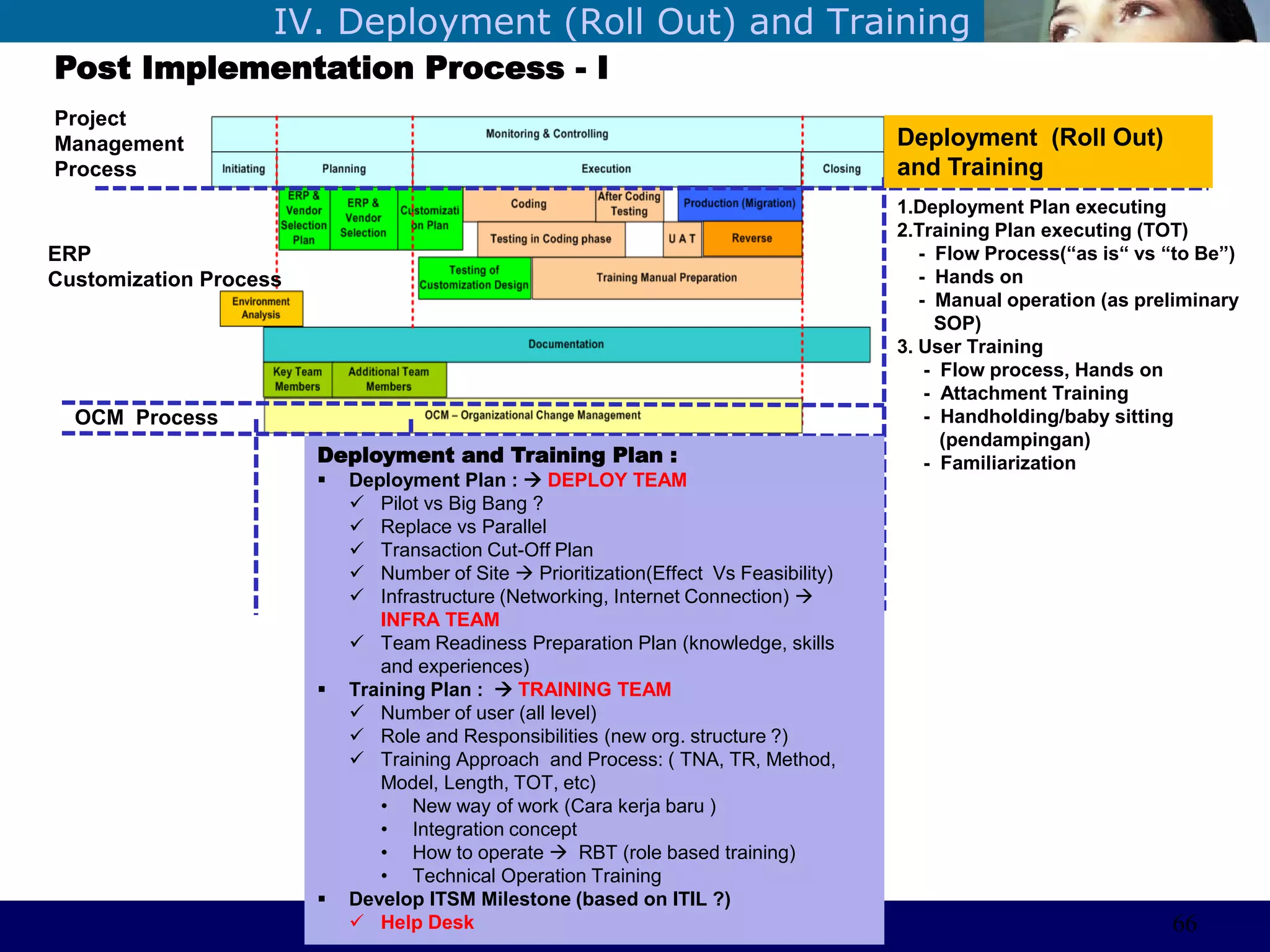

Perlunya IT DepartemenIV. Deployment (Roll Out) and Training
Post Implementation Process - I
Project
Management
Process
ERP
Customization Process
OCM Process
Deployment (Roll Out)
and Training
1.Deployment Plan executing
2.Training Plan executing (TOT)
- Flow Process(“as is“ vs “to Be”)
- Hands on
- Manual operation (as preliminary
SOP)
3. User Training
- Flow process, Hands on
- Attachment Training
- Handholding/baby sitting
(pendampingan)
- FamiliarizationDeployment and Training Plan :
 Deployment Plan :  DEPLOY TEAM
 Pilot vs Big Bang ?
 Replace vs Parallel
 Transaction Cut-Off Plan
 Number of Site  Prioritization(Effect Vs Feasibility)
 Infrastructure (Networking, Internet Connection) 
INFRA TEAM
 Team Readiness Preparation Plan (knowledge, skills
and experiences)
 Training Plan :  TRAINING TEAM
 Number of user (all level)
 Role and Responsibilities (new org. structure ?)
 Training Approach and Process: ( TNA, TR, Method,
Model, Length, TOT, etc)
• New way of work (Cara kerja baru )
• Integration concept
• How to operate  RBT (role based training)
• Technical Operation Training
 Develop ITSM Milestone (based on ITIL ?)
 Help Desk 66
©Sabaruddinde AB
Perlunya IT DepartemenV. Stabilizing and Performance Monitoring

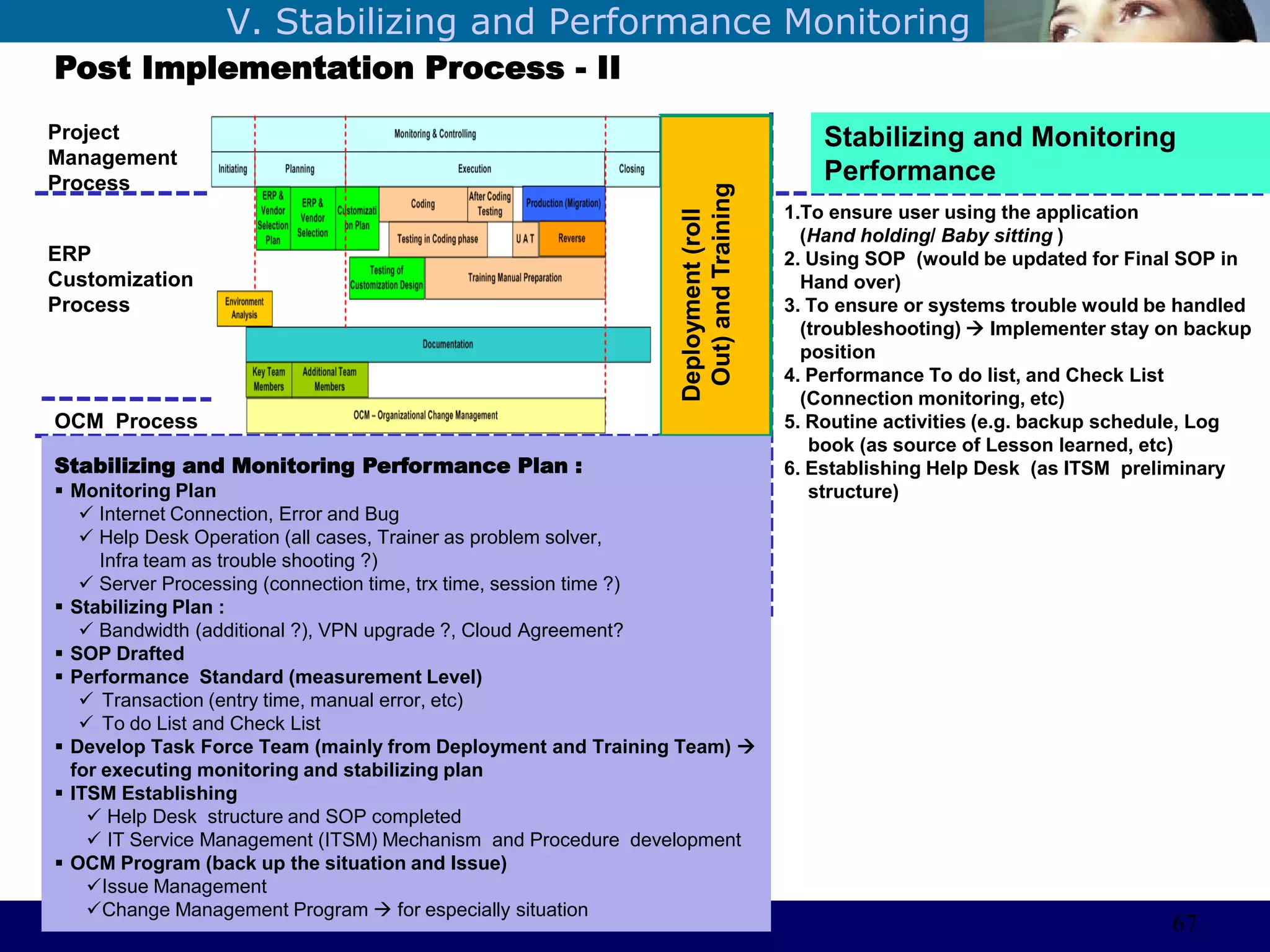

Post Implementation Process - II
Project
Management
Process
OCM Process
Stabilizing and Monitoring
Performance
1.To ensure user using the application
(Hand holding/ Baby sitting )
2. Using SOP (would be updated for Final SOP in
Hand over)
3. To ensure or systems trouble would be handled
(troubleshooting)  Implementer stay on backup
position
4. Performance To do list, and Check List
(Connection monitoring, etc)
5. Routine activities (e.g. backup schedule, Log
book (as source of Lesson learned, etc)
6. Establishing Help Desk (as ITSM preliminary
structure)
Deployment(roll
Out)andTraining
Stabilizing and Monitoring Performance Plan :
 Monitoring Plan
 Internet Connection, Error and Bug
 Help Desk Operation (all cases, Trainer as problem solver,
Infra team as trouble shooting ?)
 Server Processing (connection time, trx time, session time ?)
 Stabilizing Plan :
 Bandwidth (additional ?), VPN upgrade ?, Cloud Agreement?
 SOP Drafted
 Performance Standard (measurement Level)
 Transaction (entry time, manual error, etc)
 To do List and Check List
 Develop Task Force Team (mainly from Deployment and Training Team) 
for executing monitoring and stabilizing plan
 ITSM Establishing
 Help Desk structure and SOP completed
 IT Service Management (ITSM) Mechanism and Procedure development
 OCM Program (back up the situation and Issue)
Issue Management
Change Management Program  for especially situation
67
ERP
Customization
Process
©Sabaruddinde AB
Perlunya IT DepartemenVI. Hand-Over to Operation (Benefit Monitoring)
Post Implementation Process - III
Project
Management
Process
ERP
Customization
Process
OCM Process
Hand –Over to Operation

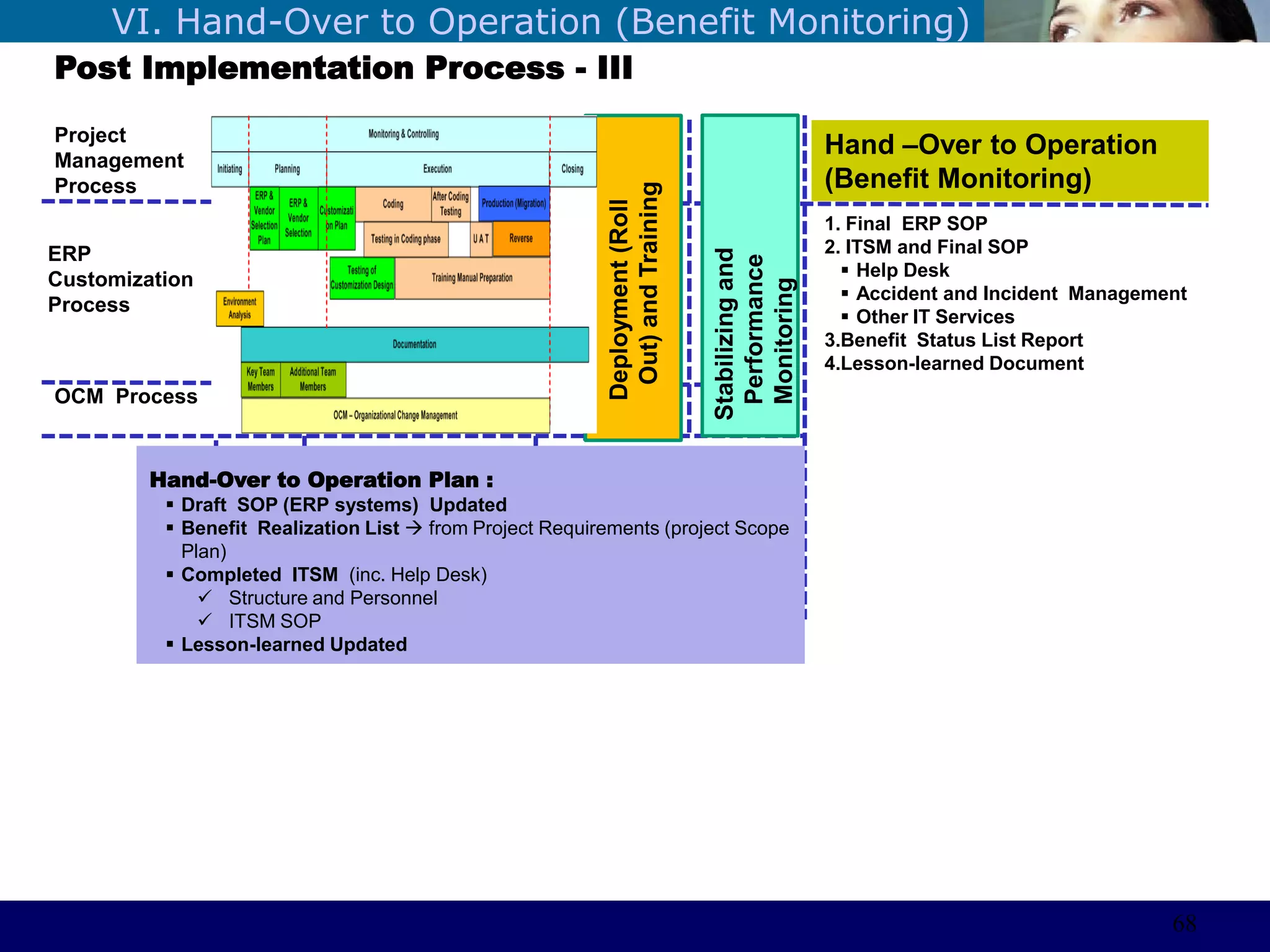

(Benefit Monitoring)
1. Final ERP SOP
2. ITSM and Final SOP
 Help Desk
 Accident and Incident Management
 Other IT Services
3.Benefit Status List Report
4.Lesson-learned Document
Deployment(Roll
Out)andTraining
Stabilizingand
Performance
Monitoring
Hand-Over to Operation Plan :
 Draft SOP (ERP systems) Updated
 Benefit Realization List  from Project Requirements (project Scope
Plan)
 Completed ITSM (inc. Help Desk)
 Structure and Personnel
 ITSM SOP
 Lesson-learned Updated
68
©Sabaruddinde AB
Perlunya IT Departemen.
Source : Internet (www)
69
©Sabaruddinde AB
Perlunya IT Departemen.
70
©Sabaruddinde AB
Appendix (All appendix take from IT PM and ERP PM Training Course by BAP Consulting )

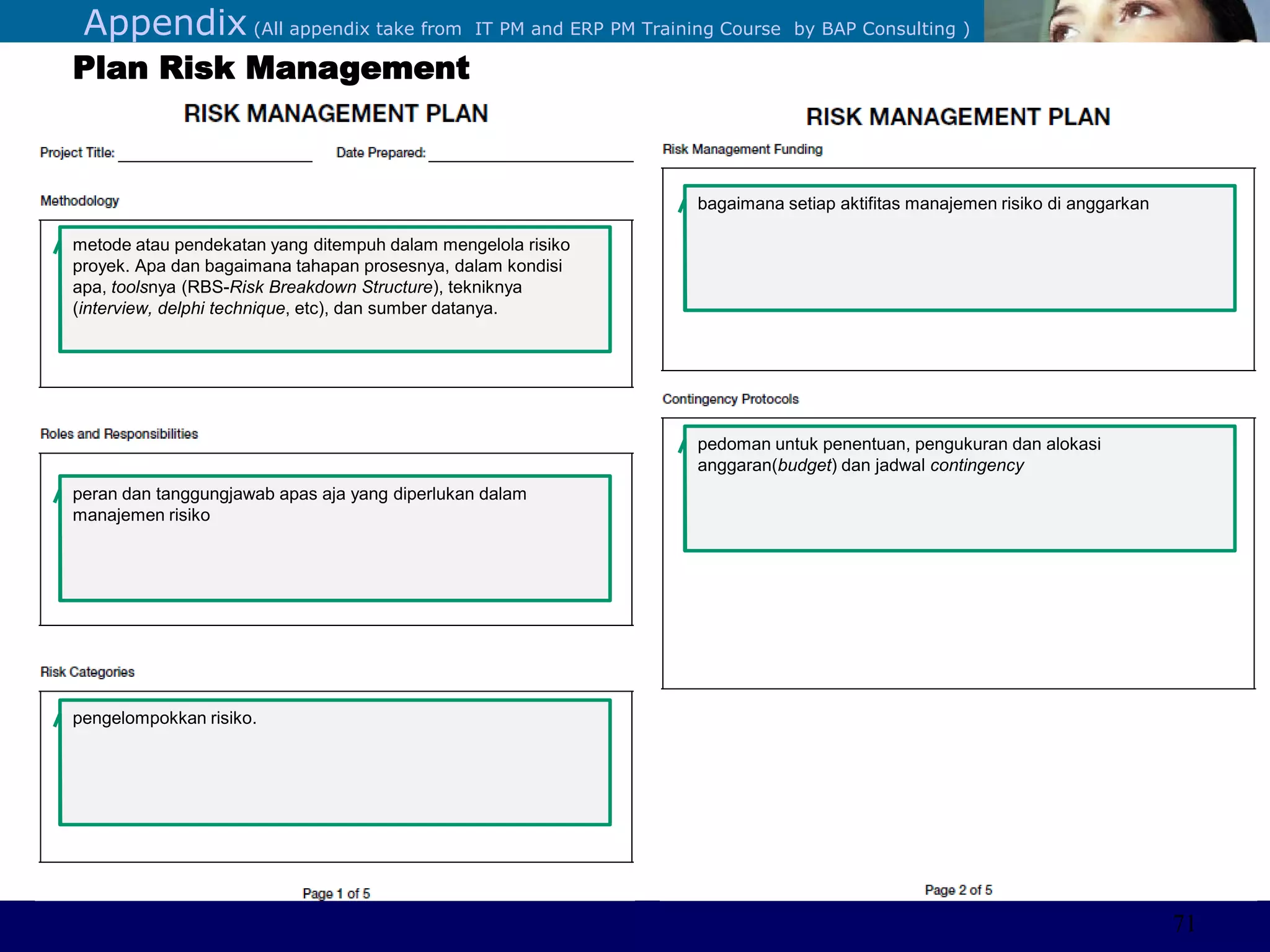

20. Plan Risk Management (Risk - 11.1)
metode atau pendekatan yang ditempuh dalam mengelola risiko
proyek. Apa dan bagaimana tahapan prosesnya, dalam kondisi
apa, toolsnya (RBS-Risk Breakdown Structure), tekniknya
(interview, delphi technique, etc), dan sumber datanya.
peran dan tanggungjawab apas aja yang diperlukan dalam
manajemen risiko
bagaimana setiap aktifitas manajemen risiko di anggarkan
pedoman untuk penentuan, pengukuran dan alokasi
anggaran(budget) dan jadwal contingency
pengelompokkan risiko.
Plan Risk Management
71
©Sabaruddinde AB
Perlunya IT DepartemenAppendix – Risk Management
Plan Risk Management

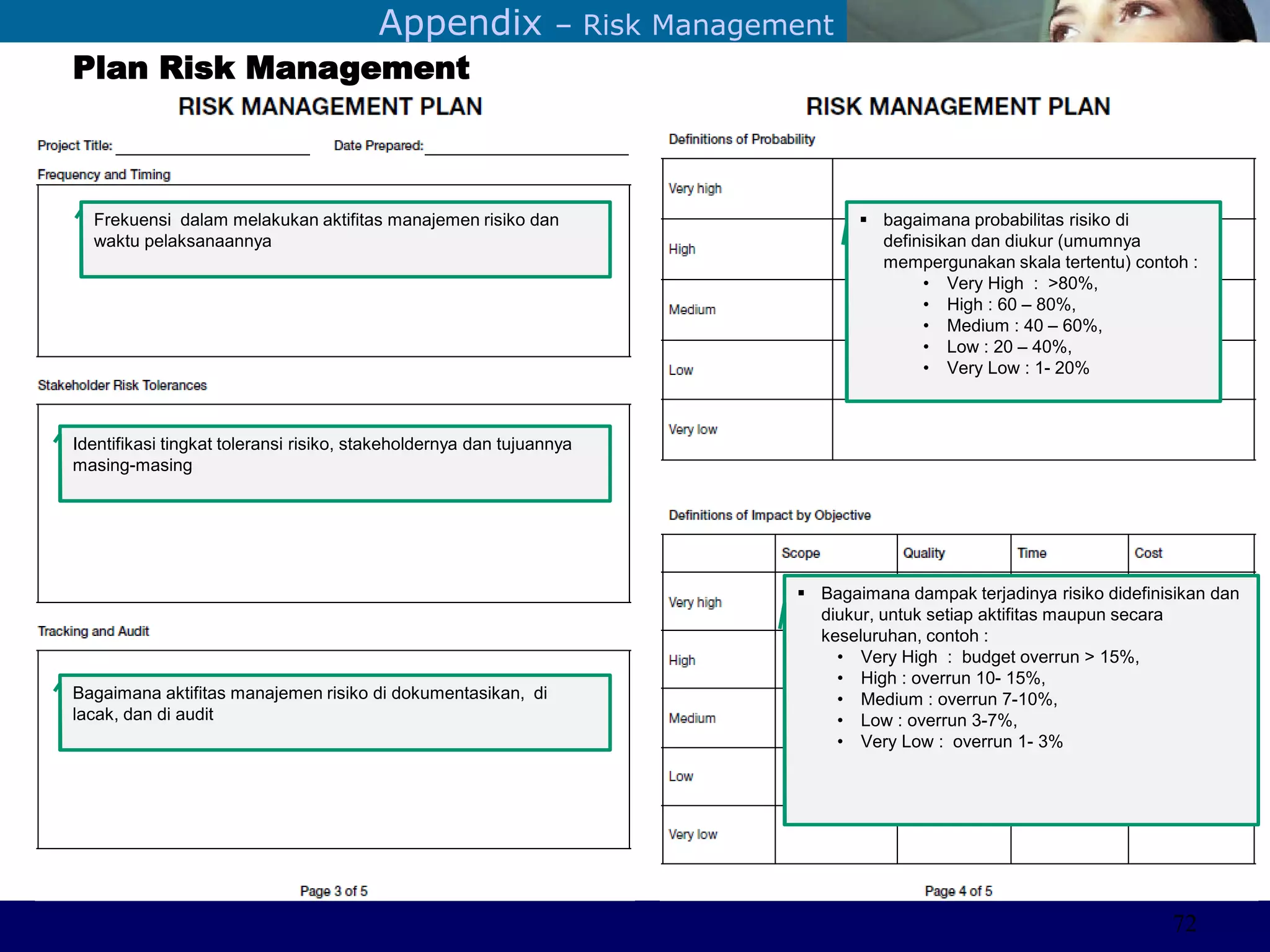

Identifikasi tingkat toleransi risiko, stakeholdernya dan tujuannya
masing-masing
Frekuensi dalam melakukan aktifitas manajemen risiko dan
waktu pelaksanaannya
Bagaimana aktifitas manajemen risiko di dokumentasikan, di
lacak, dan di audit
 Bagaimana dampak terjadinya risiko didefinisikan dan
diukur, untuk setiap aktifitas maupun secara
keseluruhan, contoh :
• Very High : budget overrun > 15%,
• High : overrun 10- 15%,
• Medium : overrun 7-10%,
• Low : overrun 3-7%,
• Very Low : overrun 1- 3%
 bagaimana probabilitas risiko di
definisikan dan diukur (umumnya
mempergunakan skala tertentu) contoh :
• Very High : >80%,
• High : 60 – 80%,
• Medium : 40 – 60%,
• Low : 20 – 40%,
• Very Low : 1- 20%
72
©Sabaruddinde AB
Perlunya IT DepartemenAppendix – Risk Management
Plan Risk Management

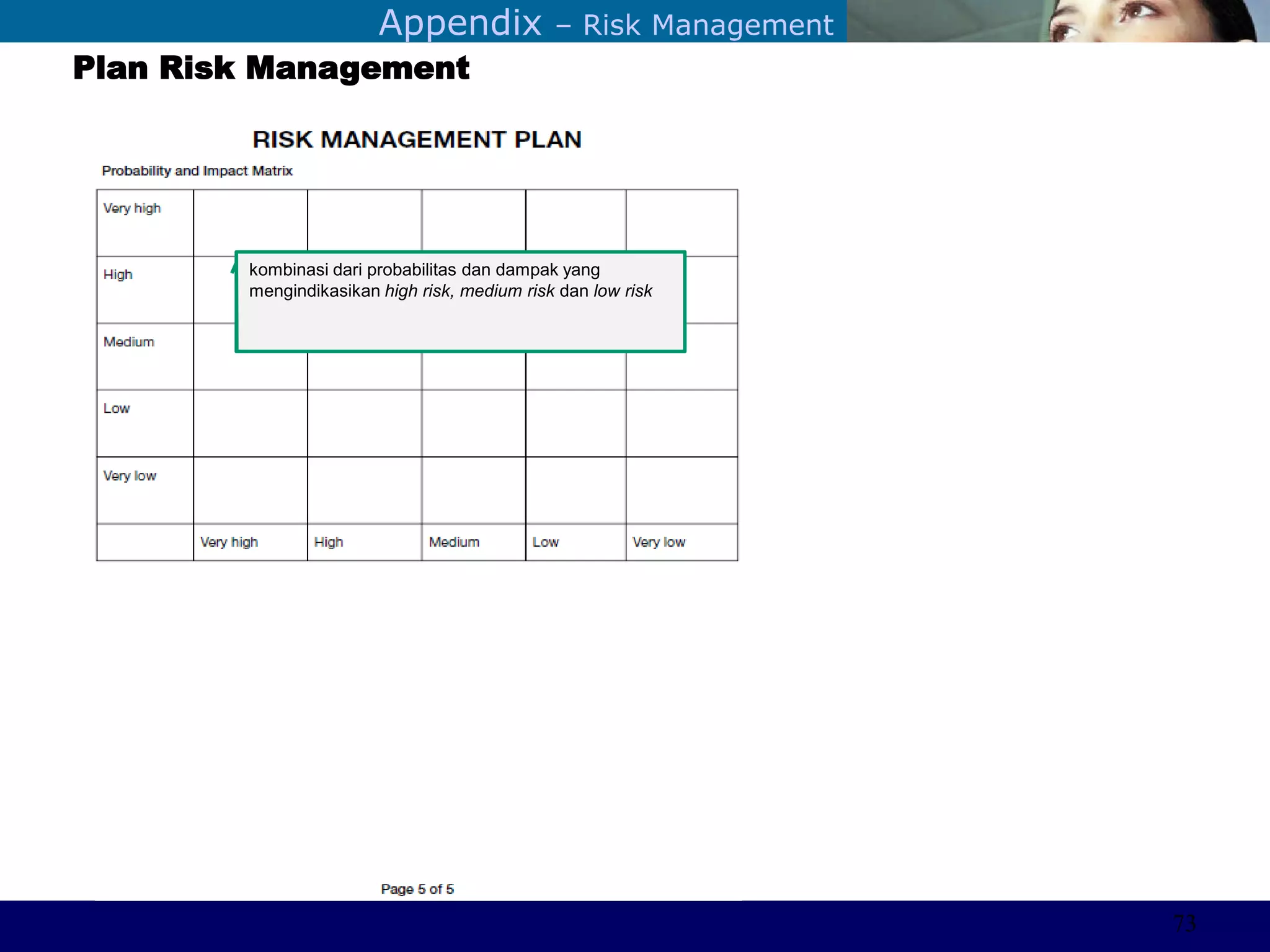

kombinasi dari probabilitas dan dampak yang
mengindikasikan high risk, medium risk dan low risk
73
©Sabaruddinde AB
Perlunya IT DepartemenAppendix – Risk Management

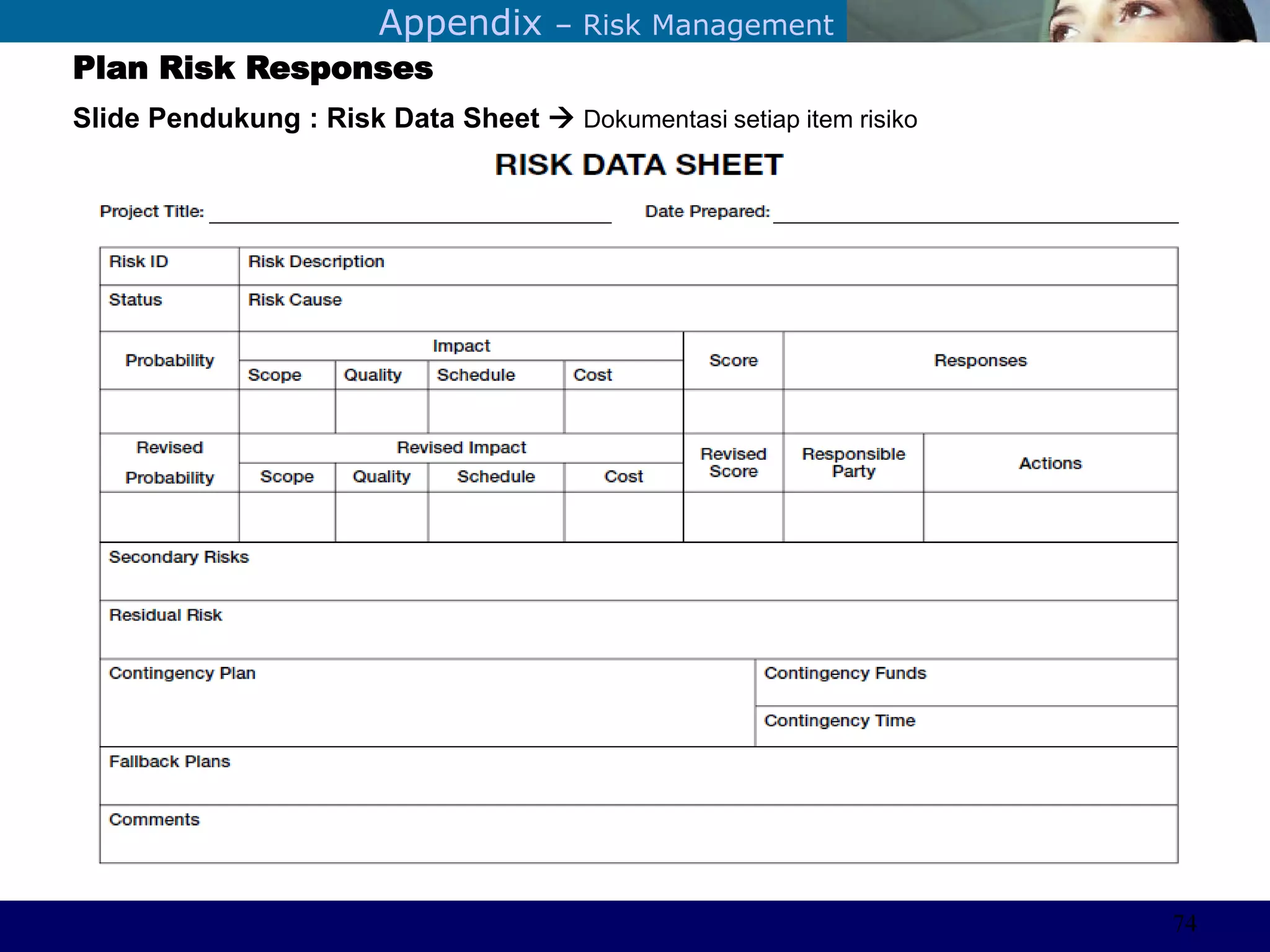

Plan Risk Responses
Slide Pendukung : Risk Data Sheet  Dokumentasi setiap item risiko
74

More Related Content

What's hot

Project portfolio management an introduction
Project portfolio management   an introductionProject portfolio management   an introduction
Project portfolio management an introduction
Anand Manimaran

Template kick off-meeting
Template kick off-meeting Template kick off-meeting
Template kick off-meeting
Hari Krishna

Project governance
Project governanceProject governance
Project governance
Glen Alleman

PMO Presentation
PMO PresentationPMO Presentation
PMO Presentation
TURKI , PMP

PMBOK 6 Summary: Module 1 (Introduction and Initiating Processes)
PMBOK 6 Summary: Module 1 (Introduction and Initiating Processes)PMBOK 6 Summary: Module 1 (Introduction and Initiating Processes)
PMBOK 6 Summary: Module 1 (Introduction and Initiating Processes)
Awaludin Zakaria

Pmo Gap Analysis Sample Itvamp 2008
Pmo Gap Analysis Sample Itvamp 2008Pmo Gap Analysis Sample Itvamp 2008
Pmo Gap Analysis Sample Itvamp 2008
ITVAMP, LLC

Introduction to Project Portfolio Management (PPM)
Introduction to Project Portfolio Management (PPM)Introduction to Project Portfolio Management (PPM)
Introduction to Project Portfolio Management (PPM)
Kimmy Chen

Overview of Program Management
Overview of Program ManagementOverview of Program Management
Overview of Program Management
Flevy.com Best Practices

Project management process and Project Management Knowledge areas
Project management process and Project Management Knowledge areasProject management process and Project Management Knowledge areas
Project management process and Project Management Knowledge areas
Mazen Zbib

PMO - Strategic Model & Concepts Overview
PMO - Strategic Model & Concepts OverviewPMO - Strategic Model & Concepts Overview
PMO - Strategic Model & Concepts Overview
PMOfficers PMOAcademy

Lec 03 project life cycle
Lec 03 project life cycleLec 03 project life cycle
Lec 03 project life cycle
SAJID ALI RUK

EA maturity models
EA maturity modelsEA maturity models
EA maturity models
Paul Sullivan

PMBOK 6 Summary: Module 2 (Planning Processes)
PMBOK 6 Summary: Module 2 (Planning Processes)PMBOK 6 Summary: Module 2 (Planning Processes)
PMBOK 6 Summary: Module 2 (Planning Processes)
Awaludin Zakaria

Difference Between TOGAF 9 and TOGAF 10
Difference Between TOGAF 9 and TOGAF 10Difference Between TOGAF 9 and TOGAF 10
Difference Between TOGAF 9 and TOGAF 10
Ashish Tandon

Implementing a Project Office Management
Implementing a Project Office ManagementImplementing a Project Office Management
Implementing a Project Office Management
Ricardo Viana Vargas

Portfolios, Programs, Projects and the Enterprise PMO
Portfolios, Programs, Projects and the Enterprise PMOPortfolios, Programs, Projects and the Enterprise PMO
Portfolios, Programs, Projects and the Enterprise PMO
Shea Heaver

Documentation Framework for IT Service Delivery
Documentation Framework for IT Service DeliveryDocumentation Framework for IT Service Delivery
Documentation Framework for IT Service Delivery
Simon Denton

PMBOK 7th Edition What is Changing?
PMBOK 7th Edition What is Changing?PMBOK 7th Edition What is Changing?
Risk Management Maturity Model (RMMM)
Risk Management Maturity Model (RMMM)Risk Management Maturity Model (RMMM)
Risk Management Maturity Model (RMMM)
Adnan Naseem

Project Management Plan
Project Management PlanProject Management Plan
Project Management Plan
Daniele Pinto

What's hot (20)

Project portfolio management an introduction
Project portfolio management   an introductionProject portfolio management   an introduction
Project portfolio management an introduction

Template kick off-meeting
Template kick off-meeting Template kick off-meeting
Template kick off-meeting

Project governance
Project governanceProject governance
Project governance

PMO Presentation
PMO PresentationPMO Presentation
PMO Presentation

PMBOK 6 Summary: Module 1 (Introduction and Initiating Processes)
PMBOK 6 Summary: Module 1 (Introduction and Initiating Processes)PMBOK 6 Summary: Module 1 (Introduction and Initiating Processes)
PMBOK 6 Summary: Module 1 (Introduction and Initiating Processes)

Pmo Gap Analysis Sample Itvamp 2008
Pmo Gap Analysis Sample Itvamp 2008Pmo Gap Analysis Sample Itvamp 2008
Pmo Gap Analysis Sample Itvamp 2008

Introduction to Project Portfolio Management (PPM)
Introduction to Project Portfolio Management (PPM)Introduction to Project Portfolio Management (PPM)
Introduction to Project Portfolio Management (PPM)

Overview of Program Management
Overview of Program ManagementOverview of Program Management
Overview of Program Management

Project management process and Project Management Knowledge areas
Project management process and Project Management Knowledge areasProject management process and Project Management Knowledge areas
Project management process and Project Management Knowledge areas

PMO - Strategic Model & Concepts Overview
PMO - Strategic Model & Concepts OverviewPMO - Strategic Model & Concepts Overview
PMO - Strategic Model & Concepts Overview

Lec 03 project life cycle
Lec 03 project life cycleLec 03 project life cycle
Lec 03 project life cycle

EA maturity models
EA maturity modelsEA maturity models
EA maturity models

PMBOK 6 Summary: Module 2 (Planning Processes)
PMBOK 6 Summary: Module 2 (Planning Processes)PMBOK 6 Summary: Module 2 (Planning Processes)
PMBOK 6 Summary: Module 2 (Planning Processes)

Difference Between TOGAF 9 and TOGAF 10
Difference Between TOGAF 9 and TOGAF 10Difference Between TOGAF 9 and TOGAF 10
Difference Between TOGAF 9 and TOGAF 10

Implementing a Project Office Management
Implementing a Project Office ManagementImplementing a Project Office Management
Implementing a Project Office Management

Portfolios, Programs, Projects and the Enterprise PMO
Portfolios, Programs, Projects and the Enterprise PMOPortfolios, Programs, Projects and the Enterprise PMO
Portfolios, Programs, Projects and the Enterprise PMO

Documentation Framework for IT Service Delivery
Documentation Framework for IT Service DeliveryDocumentation Framework for IT Service Delivery
Documentation Framework for IT Service Delivery

PMBOK 7th Edition What is Changing?
PMBOK 7th Edition What is Changing?PMBOK 7th Edition What is Changing?
PMBOK 7th Edition What is Changing?

Risk Management Maturity Model (RMMM)
Risk Management Maturity Model (RMMM)Risk Management Maturity Model (RMMM)
Risk Management Maturity Model (RMMM)

Project Management Plan
Project Management PlanProject Management Plan
Project Management Plan

Viewers also liked

Software quality metric
Software quality metricSoftware quality metric
Software quality metric
Luthfia Ulinnuha

CNH Reman Rolling Out PLM
CNH Reman Rolling Out PLMCNH Reman Rolling Out PLM
CNH Reman Rolling Out PLM
Aras

Improving Manufacturing by Simulation: Processes, Microstructure & Tooling
Improving Manufacturing by Simulation: Processes, Microstructure & ToolingImproving Manufacturing by Simulation: Processes, Microstructure & Tooling
Improving Manufacturing by Simulation: Processes, Microstructure & Tooling
Wilde Analysis Ltd.

Syed Cadcam Presentation
Syed Cadcam PresentationSyed Cadcam Presentation
Syed Cadcam Presentation
askarisyyed

flexible manufacturing systems
flexible manufacturing systemsflexible manufacturing systems
flexible manufacturing systems
Shivam Joshi

Work Breakdown Structure
Work Breakdown StructureWork Breakdown Structure
Work Breakdown Structure
Emanuele Della Valle

FLEXIBLE MANUFACTURING SYSTEM
FLEXIBLE MANUFACTURING SYSTEMFLEXIBLE MANUFACTURING SYSTEM
FLEXIBLE MANUFACTURING SYSTEM
Anand Khare

Introduction to cad cam
Introduction to cad camIntroduction to cad cam
Introduction to cad cam
parabajinkya0070

Work breakdown structure ppt
Work breakdown structure pptWork breakdown structure ppt
Work breakdown structure ppt
nazi2020

Flexible manufacturing system(FMS).
Flexible manufacturing system(FMS).Flexible manufacturing system(FMS).
Flexible manufacturing system(FMS).
Nitin Patil

Visual Design with Data
Visual Design with DataVisual Design with Data
Visual Design with Data
Seth Familian

Viewers also liked (12)

Software quality metric
Software quality metricSoftware quality metric
Software quality metric

CNH Reman Rolling Out PLM
CNH Reman Rolling Out PLMCNH Reman Rolling Out PLM
CNH Reman Rolling Out PLM

Pertemuan ke 3 - perencanaan sosial
Pertemuan ke 3 - perencanaan  sosialPertemuan ke 3 - perencanaan  sosial
Pertemuan ke 3 - perencanaan sosial

Improving Manufacturing by Simulation: Processes, Microstructure & Tooling
Improving Manufacturing by Simulation: Processes, Microstructure & ToolingImproving Manufacturing by Simulation: Processes, Microstructure & Tooling
Improving Manufacturing by Simulation: Processes, Microstructure & Tooling

Syed Cadcam Presentation
Syed Cadcam PresentationSyed Cadcam Presentation
Syed Cadcam Presentation

flexible manufacturing systems
flexible manufacturing systemsflexible manufacturing systems
flexible manufacturing systems

Work Breakdown Structure
Work Breakdown StructureWork Breakdown Structure
Work Breakdown Structure

FLEXIBLE MANUFACTURING SYSTEM
FLEXIBLE MANUFACTURING SYSTEMFLEXIBLE MANUFACTURING SYSTEM
FLEXIBLE MANUFACTURING SYSTEM

Introduction to cad cam
Introduction to cad camIntroduction to cad cam
Introduction to cad cam

Work breakdown structure ppt
Work breakdown structure pptWork breakdown structure ppt
Work breakdown structure ppt

Flexible manufacturing system(FMS).
Flexible manufacturing system(FMS).Flexible manufacturing system(FMS).
Flexible manufacturing system(FMS).

Visual Design with Data
Visual Design with DataVisual Design with Data
Visual Design with Data

Similar to Sabaruddin de AB_S_Six Step ERP Project Management_FINAL

ERP Key Success Factors Series 2
ERP Key Success Factors Series 2ERP Key Success Factors Series 2
ERP Key Success Factors Series 2
velcomerp

Startup program management
Startup program managementStartup program management
Startup program management
Becky Flint

Resume of Juari
Resume of JuariResume of Juari
Resume of Juari
Juari .

Getting Ready for ERP Implementation
Getting Ready for ERP ImplementationGetting Ready for ERP Implementation
Getting Ready for ERP Implementation
Mauly Chandra

ERP Key Success Factors Series 1
ERP Key Success Factors Series 1ERP Key Success Factors Series 1
ERP Key Success Factors Series 1
velcomerp

Sahar Kamal's CV _2016
Sahar Kamal's CV _2016Sahar Kamal's CV _2016
Sahar Kamal's CV _2016
Sahar Kamal

ASAP-01 Implementaion.pptx
ASAP-01 Implementaion.pptxASAP-01 Implementaion.pptx
ASAP-01 Implementaion.pptx
Ashraf206702

Portfolio_Pattarome_Final
Portfolio_Pattarome_FinalPortfolio_Pattarome_Final
Portfolio_Pattarome_Final
Pattarome Thammasiri

Establishing an Effective PMO
Establishing an Effective PMOEstablishing an Effective PMO
Establishing an Effective PMO
Business Beam

Getting Some Respect - How to Measure and Communicate Your EA Success
Getting Some Respect - How to Measure and Communicate Your EA SuccessGetting Some Respect - How to Measure and Communicate Your EA Success
Getting Some Respect - How to Measure and Communicate Your EA Success
David Baker

Practical experiences of portfolio management
Practical experiences of portfolio managementPractical experiences of portfolio management
Practical experiences of portfolio management
Association for Project Management

Velcom Profile
Velcom ProfileVelcom Profile
Velcom Profile
Siva Subramanian TS

Master IT balanced scorecard (final).pptx
Master IT balanced scorecard (final).pptxMaster IT balanced scorecard (final).pptx
Master IT balanced scorecard (final).pptx
Glen Alleman

ERP SYSTEM POST IMPLEMENTATION AUDIT_TRNG_May,2023 - Part-1.pptx
ERP SYSTEM POST IMPLEMENTATION AUDIT_TRNG_May,2023 - Part-1.pptxERP SYSTEM POST IMPLEMENTATION AUDIT_TRNG_May,2023 - Part-1.pptx
ERP SYSTEM POST IMPLEMENTATION AUDIT_TRNG_May,2023 - Part-1.pptx
RamanaBulusu1

PMI Global Congress 2005: Portfolio and Program Management implementation in ...
PMI Global Congress 2005: Portfolio and Program Management implementation in ...PMI Global Congress 2005: Portfolio and Program Management implementation in ...
PMI Global Congress 2005: Portfolio and Program Management implementation in ...
Thomas Walenta, PMI Fellow

Ramakoti
RamakotiRamakoti
Ramakoti
Ramakoti Reddy

NUS-ISS Job Placement and Professional Conversion Programmes (PCP) (for Emplo...
NUS-ISS Job Placement and Professional Conversion Programmes (PCP) (for Emplo...NUS-ISS Job Placement and Professional Conversion Programmes (PCP) (for Emplo...
NUS-ISS Job Placement and Professional Conversion Programmes (PCP) (for Emplo...
NUS-ISS

14.1 features
14.1 features14.1 features
14.1 features
Curtis Tsang

م.47-#تواصل_تطوير-م.محمد العربى-إستخدام مفاهيم الرشاقة للتحول الإستراتيجي للم...
م.47-#تواصل_تطوير-م.محمد العربى-إستخدام مفاهيم الرشاقة للتحول الإستراتيجي للم...م.47-#تواصل_تطوير-م.محمد العربى-إستخدام مفاهيم الرشاقة للتحول الإستراتيجي للم...
م.47-#تواصل_تطوير-م.محمد العربى-إستخدام مفاهيم الرشاقة للتحول الإستراتيجي للم...
Egyptian Engineers Association

ERP Logic corporate Presentation
ERP Logic corporate PresentationERP Logic corporate Presentation
ERP Logic corporate Presentation
caldnambi

Similar to Sabaruddin de AB_S_Six Step ERP Project Management_FINAL (20)

ERP Key Success Factors Series 2
ERP Key Success Factors Series 2ERP Key Success Factors Series 2
ERP Key Success Factors Series 2

Startup program management
Startup program managementStartup program management
Startup program management

Resume of Juari
Resume of JuariResume of Juari
Resume of Juari

Getting Ready for ERP Implementation
Getting Ready for ERP ImplementationGetting Ready for ERP Implementation
Getting Ready for ERP Implementation

ERP Key Success Factors Series 1
ERP Key Success Factors Series 1ERP Key Success Factors Series 1
ERP Key Success Factors Series 1

Sahar Kamal's CV _2016
Sahar Kamal's CV _2016Sahar Kamal's CV _2016
Sahar Kamal's CV _2016

ASAP-01 Implementaion.pptx
ASAP-01 Implementaion.pptxASAP-01 Implementaion.pptx
ASAP-01 Implementaion.pptx

Portfolio_Pattarome_Final
Portfolio_Pattarome_FinalPortfolio_Pattarome_Final
Portfolio_Pattarome_Final

Establishing an Effective PMO
Establishing an Effective PMOEstablishing an Effective PMO
Establishing an Effective PMO

Getting Some Respect - How to Measure and Communicate Your EA Success
Getting Some Respect - How to Measure and Communicate Your EA SuccessGetting Some Respect - How to Measure and Communicate Your EA Success
Getting Some Respect - How to Measure and Communicate Your EA Success

Practical experiences of portfolio management
Practical experiences of portfolio managementPractical experiences of portfolio management
Practical experiences of portfolio management

Velcom Profile
Velcom ProfileVelcom Profile
Velcom Profile

Master IT balanced scorecard (final).pptx
Master IT balanced scorecard (final).pptxMaster IT balanced scorecard (final).pptx
Master IT balanced scorecard (final).pptx

ERP SYSTEM POST IMPLEMENTATION AUDIT_TRNG_May,2023 - Part-1.pptx
ERP SYSTEM POST IMPLEMENTATION AUDIT_TRNG_May,2023 - Part-1.pptxERP SYSTEM POST IMPLEMENTATION AUDIT_TRNG_May,2023 - Part-1.pptx
ERP SYSTEM POST IMPLEMENTATION AUDIT_TRNG_May,2023 - Part-1.pptx

PMI Global Congress 2005: Portfolio and Program Management implementation in ...
PMI Global Congress 2005: Portfolio and Program Management implementation in ...PMI Global Congress 2005: Portfolio and Program Management implementation in ...
PMI Global Congress 2005: Portfolio and Program Management implementation in ...

Ramakoti
RamakotiRamakoti
Ramakoti

NUS-ISS Job Placement and Professional Conversion Programmes (PCP) (for Emplo...
NUS-ISS Job Placement and Professional Conversion Programmes (PCP) (for Emplo...NUS-ISS Job Placement and Professional Conversion Programmes (PCP) (for Emplo...
NUS-ISS Job Placement and Professional Conversion Programmes (PCP) (for Emplo...

14.1 features
14.1 features14.1 features
14.1 features

م.47-#تواصل_تطوير-م.محمد العربى-إستخدام مفاهيم الرشاقة للتحول الإستراتيجي للم...
م.47-#تواصل_تطوير-م.محمد العربى-إستخدام مفاهيم الرشاقة للتحول الإستراتيجي للم...م.47-#تواصل_تطوير-م.محمد العربى-إستخدام مفاهيم الرشاقة للتحول الإستراتيجي للم...
م.47-#تواصل_تطوير-م.محمد العربى-إستخدام مفاهيم الرشاقة للتحول الإستراتيجي للم...

ERP Logic corporate Presentation
ERP Logic corporate PresentationERP Logic corporate Presentation
ERP Logic corporate Presentation

Recently uploaded

Operational ease MuleSoft and Salesforce Service Cloud Solution v1.0.pptx
Operational ease MuleSoft and Salesforce Service Cloud Solution v1.0.pptxOperational ease MuleSoft and Salesforce Service Cloud Solution v1.0.pptx
Operational ease MuleSoft and Salesforce Service Cloud Solution v1.0.pptx
sandeepmenon62

What is Continuous Testing in DevOps - A Definitive Guide.pdf
What is Continuous Testing in DevOps - A Definitive Guide.pdfWhat is Continuous Testing in DevOps - A Definitive Guide.pdf
What is Continuous Testing in DevOps - A Definitive Guide.pdf
kalichargn70th171

J-Spring 2024 - Going serverless with Quarkus, GraalVM native images and AWS ...
J-Spring 2024 - Going serverless with Quarkus, GraalVM native images and AWS ...J-Spring 2024 - Going serverless with Quarkus, GraalVM native images and AWS ...
J-Spring 2024 - Going serverless with Quarkus, GraalVM native images and AWS ...
Bert Jan Schrijver

TMU毕业证书精仿办理
TMU毕业证书精仿办理TMU毕业证书精仿办理
TMU毕业证书精仿办理
aeeva

ppt on the brain chip neuralink.pptx
ppt  on   the brain  chip neuralink.pptxppt  on   the brain  chip neuralink.pptx
ppt on the brain chip neuralink.pptx
Reetu63

Orca: Nocode Graphical Editor for Container Orchestration
Orca: Nocode Graphical Editor for Container OrchestrationOrca: Nocode Graphical Editor for Container Orchestration
Orca: Nocode Graphical Editor for Container Orchestration
Pedro J. Molina

Assure Contact Center Experiences for Your Customers With ThousandEyes
Assure Contact Center Experiences for Your Customers With ThousandEyesAssure Contact Center Experiences for Your Customers With ThousandEyes
Assure Contact Center Experiences for Your Customers With ThousandEyes
ThousandEyes

Why Apache Kafka Clusters Are Like Galaxies (And Other Cosmic Kafka Quandarie...
Why Apache Kafka Clusters Are Like Galaxies (And Other Cosmic Kafka Quandarie...Why Apache Kafka Clusters Are Like Galaxies (And Other Cosmic Kafka Quandarie...
Why Apache Kafka Clusters Are Like Galaxies (And Other Cosmic Kafka Quandarie...
Paul Brebner

Voxxed Days Trieste 2024 - Unleashing the Power of Vector Search and Semantic...
Voxxed Days Trieste 2024 - Unleashing the Power of Vector Search and Semantic...Voxxed Days Trieste 2024 - Unleashing the Power of Vector Search and Semantic...
Voxxed Days Trieste 2024 - Unleashing the Power of Vector Search and Semantic...
Luigi Fugaro

The Rising Future of CPaaS in the Middle East 2024
The Rising Future of CPaaS in the Middle East 2024The Rising Future of CPaaS in the Middle East 2024
The Rising Future of CPaaS in the Middle East 2024
Yara Milbes

Going AOT: Everything you need to know about GraalVM for Java applications
Going AOT: Everything you need to know about GraalVM for Java applicationsGoing AOT: Everything you need to know about GraalVM for Java applications
Going AOT: Everything you need to know about GraalVM for Java applications
Alina Yurenko

WMF 2024 - Unlocking the Future of Data Powering Next-Gen AI with Vector Data...
WMF 2024 - Unlocking the Future of Data Powering Next-Gen AI with Vector Data...WMF 2024 - Unlocking the Future of Data Powering Next-Gen AI with Vector Data...
WMF 2024 - Unlocking the Future of Data Powering Next-Gen AI with Vector Data...
Luigi Fugaro

Mobile App Development Company In Noida | Drona Infotech
Mobile App Development Company In Noida | Drona InfotechMobile App Development Company In Noida | Drona Infotech
Mobile App Development Company In Noida | Drona Infotech
Drona Infotech

Modelling Up - DDDEurope 2024 - Amsterdam
Modelling Up - DDDEurope 2024 - AmsterdamModelling Up - DDDEurope 2024 - Amsterdam
Modelling Up - DDDEurope 2024 - Amsterdam
Alberto Brandolini

14 th Edition of International conference on computer vision
14 th Edition of International conference on computer vision14 th Edition of International conference on computer vision
14 th Edition of International conference on computer vision
ShulagnaSarkar2

Safelyio Toolbox Talk Softwate & App (How To Digitize Safety Meetings)
Safelyio Toolbox Talk Softwate & App (How To Digitize Safety Meetings)Safelyio Toolbox Talk Softwate & App (How To Digitize Safety Meetings)
Safelyio Toolbox Talk Softwate & App (How To Digitize Safety Meetings)
safelyiotech

Superpower Your Apache Kafka Applications Development with Complementary Open...
Superpower Your Apache Kafka Applications Development with Complementary Open...Superpower Your Apache Kafka Applications Development with Complementary Open...
Superpower Your Apache Kafka Applications Development with Complementary Open...
Paul Brebner

美洲杯赔率投注网【​网址​🎉3977·EE​🎉】
美洲杯赔率投注网【​网址​🎉3977·EE​🎉】美洲杯赔率投注网【​网址​🎉3977·EE​🎉】
美洲杯赔率投注网【​网址​🎉3977·EE​🎉】
widenerjobeyrl638

All you need to know about Spring Boot and GraalVM
All you need to know about Spring Boot and GraalVMAll you need to know about Spring Boot and GraalVM
All you need to know about Spring Boot and GraalVM
Alina Yurenko

Recently uploaded (20)

Operational ease MuleSoft and Salesforce Service Cloud Solution v1.0.pptx
Operational ease MuleSoft and Salesforce Service Cloud Solution v1.0.pptxOperational ease MuleSoft and Salesforce Service Cloud Solution v1.0.pptx
Operational ease MuleSoft and Salesforce Service Cloud Solution v1.0.pptx

What is Continuous Testing in DevOps - A Definitive Guide.pdf
What is Continuous Testing in DevOps - A Definitive Guide.pdfWhat is Continuous Testing in DevOps - A Definitive Guide.pdf
What is Continuous Testing in DevOps - A Definitive Guide.pdf

J-Spring 2024 - Going serverless with Quarkus, GraalVM native images and AWS ...
J-Spring 2024 - Going serverless with Quarkus, GraalVM native images and AWS ...J-Spring 2024 - Going serverless with Quarkus, GraalVM native images and AWS ...
J-Spring 2024 - Going serverless with Quarkus, GraalVM native images and AWS ...

TMU毕业证书精仿办理
TMU毕业证书精仿办理TMU毕业证书精仿办理
TMU毕业证书精仿办理

ppt on the brain chip neuralink.pptx
ppt  on   the brain  chip neuralink.pptxppt  on   the brain  chip neuralink.pptx
ppt on the brain chip neuralink.pptx

Orca: Nocode Graphical Editor for Container Orchestration
Orca: Nocode Graphical Editor for Container OrchestrationOrca: Nocode Graphical Editor for Container Orchestration
Orca: Nocode Graphical Editor for Container Orchestration

Assure Contact Center Experiences for Your Customers With ThousandEyes
Assure Contact Center Experiences for Your Customers With ThousandEyesAssure Contact Center Experiences for Your Customers With ThousandEyes
Assure Contact Center Experiences for Your Customers With ThousandEyes

Why Apache Kafka Clusters Are Like Galaxies (And Other Cosmic Kafka Quandarie...
Why Apache Kafka Clusters Are Like Galaxies (And Other Cosmic Kafka Quandarie...Why Apache Kafka Clusters Are Like Galaxies (And Other Cosmic Kafka Quandarie...
Why Apache Kafka Clusters Are Like Galaxies (And Other Cosmic Kafka Quandarie...

Voxxed Days Trieste 2024 - Unleashing the Power of Vector Search and Semantic...
Voxxed Days Trieste 2024 - Unleashing the Power of Vector Search and Semantic...Voxxed Days Trieste 2024 - Unleashing the Power of Vector Search and Semantic...
Voxxed Days Trieste 2024 - Unleashing the Power of Vector Search and Semantic...

The Rising Future of CPaaS in the Middle East 2024
The Rising Future of CPaaS in the Middle East 2024The Rising Future of CPaaS in the Middle East 2024
The Rising Future of CPaaS in the Middle East 2024

Going AOT: Everything you need to know about GraalVM for Java applications
Going AOT: Everything you need to know about GraalVM for Java applicationsGoing AOT: Everything you need to know about GraalVM for Java applications
Going AOT: Everything you need to know about GraalVM for Java applications

WMF 2024 - Unlocking the Future of Data Powering Next-Gen AI with Vector Data...
WMF 2024 - Unlocking the Future of Data Powering Next-Gen AI with Vector Data...WMF 2024 - Unlocking the Future of Data Powering Next-Gen AI with Vector Data...
WMF 2024 - Unlocking the Future of Data Powering Next-Gen AI with Vector Data...

Mobile App Development Company In Noida | Drona Infotech
Mobile App Development Company In Noida | Drona InfotechMobile App Development Company In Noida | Drona Infotech
Mobile App Development Company In Noida | Drona Infotech

Modelling Up - DDDEurope 2024 - Amsterdam
Modelling Up - DDDEurope 2024 - AmsterdamModelling Up - DDDEurope 2024 - Amsterdam
Modelling Up - DDDEurope 2024 - Amsterdam

14 th Edition of International conference on computer vision
14 th Edition of International conference on computer vision14 th Edition of International conference on computer vision
14 th Edition of International conference on computer vision

bgiolcb
bgiolcbbgiolcb
bgiolcb

Safelyio Toolbox Talk Softwate & App (How To Digitize Safety Meetings)
Safelyio Toolbox Talk Softwate & App (How To Digitize Safety Meetings)Safelyio Toolbox Talk Softwate & App (How To Digitize Safety Meetings)
Safelyio Toolbox Talk Softwate & App (How To Digitize Safety Meetings)

Superpower Your Apache Kafka Applications Development with Complementary Open...
Superpower Your Apache Kafka Applications Development with Complementary Open...Superpower Your Apache Kafka Applications Development with Complementary Open...
Superpower Your Apache Kafka Applications Development with Complementary Open...

美洲杯赔率投注网【​网址​🎉3977·EE​🎉】
美洲杯赔率投注网【​网址​🎉3977·EE​🎉】美洲杯赔率投注网【​网址​🎉3977·EE​🎉】
美洲杯赔率投注网【​网址​🎉3977·EE​🎉】

All you need to know about Spring Boot and GraalVM
All you need to know about Spring Boot and GraalVMAll you need to know about Spring Boot and GraalVM
All you need to know about Spring Boot and GraalVM

Sabaruddin de AB_S_Six Step ERP Project Management_FINAL

  • 1. ©Sabaruddinde AB IT Management Series © Ir. Sabaruddin de AB, M.AB BAP – Managing Partner Sabaruddin.deab@yahoo.com 0816554309 ERP Project Management Successful in Managing ERP Implementation 1
  • 2. ©Sabaruddinde AB Perlunya IT DepartemenFrom the Author This presentation has been prepared for general guidance on matters of interest only, and does not constitute professional advice. You should not act upon the information contained in this presentation without obtaining specific professional advice from the author. No representation or warranty (express or implied) is given as to the accuracy or completeness of the information contained in this presentation, and, to the extent permitted by law. The author does not accept or assume any liability, responsibility or duty of care for any consequences of you or anyone else acting, or refraining to act, in reliance on the information contained in this presentation or for any decision based on it. © 2015 by Sabaruddin de AB. All rights reserved. No copying in any form is permitted. It may not be reproduced, distributed, stored in a retrieval system, or transmitted in any form or by any means, in part or in whole, without the express written permission of the author. Trademarked names may appear in this presentation. Rather than use a trademark symbol with every occurrence of a trademarked name, we use the names only in an editorial fashion and to the benefit of the trademark owner, with no intention of infringement of the trademark. Presented on ―High Impact Seminar‖ ERP Project Management: Successful in Managing ERP Implementation, October 31st 2015, in cooperation with STIMIK ASIA Malang. Primary source of this presentation material take from curriculum and material of IT Project Management and ERP Project Management Training Course designed by BAP Consulting 2
  • 3. ©Sabaruddinde AB Perlunya IT Departemen Objectives Introduction  To gain better approach in managing ERP Implementation  To provide knowledge on effective ERP Project management to conduct day to day Project Management Practices  To provide participants with key soft-skills that are important in ERP Project management Practices 3
  • 4. ©Sabaruddinde AB Perlunya IT DepartemenIntroduction ERP : What ? ERP Vendor and Product : Source : Internet (www) 4
  • 5. ©Sabaruddinde AB Perlunya IT DepartemenIntroduction ERP (Enterprise Resources Planning) Implementation The FACTS : What ? :  Project completed late, over budget, or not meeting the functionality requirements of your client  Projects are successful in spite of lack of planning and project management, through heavy stress and overtime work throughout the life cycle Why ? :  Weak standard processes and techniques used inconsistently by project managers  Project management is reactive and not seen as providing value  The time required to manage projects proactively is not built into the workplan, since it is considered ―overhead‖ The answer is …….You need a Good Project Management 5
  • 6. ©Sabaruddinde AB Perlunya IT DepartemenIntroduction PMBOK © Guide 5th Edition : Project Management is  An inclusive term that describes the sum of knowledge within the profession of project management that is generally recognized as good practice.  Provides guidelines for managing individual projects and defines project management related concepts. It also describes the project management life cycle and its related processes, as well as the project life cycle. What is a Project ? A project is a temporary endeavor undertaken to create unique product, service or result.  Temporary : has a definite BEGINNING and has a definite END  Unique : differentiate by several distinguish conditions (location, design, circumstances and situations, stakeholders, and so on). Project Management Process (provide by PMI) © PMI, PMBOK Guide 5th Edition 6
  • 7. ©Sabaruddinde AB Perlunya IT DepartemenWhy Business/Organization need ERP Implementation. 7
  • 8. ©Sabaruddinde AB Perlunya IT DepartemenLearned from previous experiences (others company, survey, SME, etc) Why some ERP Implementation Failure ? 1. Lack of Education (Not Understanding what the new ―systems‖ (to be) is designed to achieve and its benefit) 2. Lack of users involvement 3. Lack of Management support 4. Lack of Project Management knowledge and Skills (Project Manager and Project Team) 5. Inadequate Requirements Definition (current processes are not adequately addressed ―as well as To Be ―) 6. Poor ERP Package Selection (the package does not address the basic business functions of the client) 7. Inadequate Resources employed by the Client 8. Internal Resistance to changing the 'old' processes 9. A Poor fit between the software and users procedures 10. Unrealistic Expectations of the Benefits and the ROI 11. Inadequate training (users do not properly how to use the new tool) 12. Unrealistic Time Frame Expectations 13. A Bottom up approach is employed (the Process is not viewed as a Top Management priority) 14. The client does not properly address and plan for the expenses involved. Source : Research Result from Internet WWW 8
  • 9. ©Sabaruddinde AB Perlunya IT DepartemenERP Implementation Methodology. ERP Implementation Methodology : (Mainly in technical aspect) ASAP (Accelerated SAP) Oracle AIM – Application Implementation Methodology © Oracle © SAP, AG 9
  • 10. ©Sabaruddinde AB Perlunya IT DepartemenERP Implementation - Strategy Road Map : S-six step of ERP Implementation ( a Lesson-learned) Assessment Pre- Implementation 1 Implementation Hand-over to Operation (Benefit Monitoring) Stabilizing and Performance Monitoring (Hands Holding) Deployment and Training 5 6 432 10
  • 11. ©Sabaruddinde AB Perlunya IT DepartemenI. Assessment I. Assessment : (Organizational Readiness) 1. Check your Organization’s IT Master Plan  Memahami strategi Perusahaan/Organisasi akan memudahkan dalam alignment tujuan implementasi ERP sesuai dengan tujuan perusahaan  Memastikan proyek ERP telah ada dalam peta jalan strategi bisnis  Memastikan manfaat bagi organisasi/bisnis (Business Benefit) dan Permasalahan Bisnis yang ingin diselesaikan (Preliminary Business Case) tersedia 2. How about your IT Project Management Framework in your Organization ? Tools and Technique : - Expert Judgment, Meeting 11
  • 12. ©Sabaruddinde AB Perlunya IT DepartemenI. Assessment 2. How about your IT Project Management Framework in your Organization (cont’d)  The concept in Building Project Management Methodology Tools and Technique : - Expert Judgment 12
  • 13. ©Sabaruddinde AB Perlunya IT DepartemenI. Assessment 3. How about your Project Organization Structure ? Client CompanyVendor PMO PM PM Vendor Team (Analyst, Programmer etc) Client Team (Analyst, Programmer, Key Users. etc) Project Sponsor Tools and Technique : - Expert Judgment 13
  • 14. ©Sabaruddinde AB Perlunya IT DepartemenI. Assessment 4. Internal Team : Skills and Knowledge  Team Readiness Factor Preparation  Pre-Assignment (PMBOK-Human Resource 9.2 Acquire Project Team)  Lack of knowledge  training pendahuluan, misalnya introduction to ERP project management © Bruce, Andy and Langdon, Ken, Project Management Client Company Do you need an advisor (SME) ? Tools and Technique : - Expert Judgment 14
  • 15. ©Sabaruddinde AB Perlunya IT DepartemenI. Assessment 5. How about the Organization Business Process ?  ERP membutuhkan proses bisnis yang telah terdefinisi (rule bisnis yang jelas)  menjamin Integrasi bisa dilakukan  Proses bisnis yang jelas (terstruktur dengan baik) memudahkan dalam penerapan SATKER KPPN BANK INDONESIA BNI, BRI, MANDIRI DJPBN K/L- Kementerian Dan Lembaga © Hashim, Ali., and Allan, Bill. 2001. Treasury Reference Model, Worl dBank Tools and Technique : - Expert Judgment 15
  • 16. ©Sabaruddinde AB Perlunya IT DepartemenII. Pre-Implementation II. Pre-Implementation Objective : 1. Memastikan tujuan, arah dan maksud implementasi ERP sesuain dengan strategi organisasi/ bisnis 2. Meningkatkan kesiapan organisasi dalam menerima implementasi ERP, khususnya yang terkait dengan perubahan pada budaya kerja dan pola kerja 3. Menyiapkan pola kerjasama team (team work) bagi calon anggota team proyek implementasi ERP. How ? 1. Organizational Readiness Assessment  Kesiapan organisasi (berubah) sesuai dengan tuntutan ERP  Kemampuan Team Internal  Key team members  Approach :  Seminar  Build Awareness  Workshop  Create Collaboration, Coordination  Training  Develop Key team members readiness 2. Determine ERP Implementation Goals  Diturunkan secara rinci (detail) dari mapping business benefit (advantage, competitive aspect) dari IT Master Plan dan IT Road Map  Merupakan detail sasaran dari implementasi ERP yang meliputi  Daftar integrasi yang muncul antar setiap area proses bisnis  Manfaat (efisiensi dan efektifitas) baik di tingkat pelaksanaan fungsi operasional, maupun pengambilan keputusan di tingkat manajemen dalam setiap proses bisnis Tools and Technique :  Subject Matter Experts  Meeting  Benchmarking Menjawab hasil Assessment  Set up the Organizational Readiness 16
  • 17. ©Sabaruddinde AB Perlunya IT DepartemenII. Pre-Implementation How ? (cont’d) 3. Business Process Re-engineering  Penyiapan Integrasi dan optimasi aliran data dan informasi cross functional (antar proses bisnis)  Pemetaan potensi benefit (keuntungan) dalam (―As Is‖ vs ―To Be‖)  Efektifitas dalam setiap siklus/tahapan proses bisnis dan secara keseluruhan  Efisiensi dalam setiap proses bisnis dan organisasi secara keseluruhan (di rangkum dalam business case)  Business benefit vs Cost Output : 1. Organizational Readiness Report (1st Assessment) 2. Business Process Integration Report (BPR Report) Memberikan dasar dalam penyusunan rincian Business Requirements 17
  • 18. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation 1. Initiating Project Manager Assignment Tools and Technique :  Expert Judgment (SME)  Facilitation Techniques (Brainstorming, Focus Group) Who is Project Manager ? A person that is RESPONSIBLE for : achieving the project’s overall objectives and leading the project team. Project Manager Responsibilities  Providing thought leadership and vision  Planning and organizing the project  Organizing and managing the project team  Estimating cost and developing project budget  Monitoring and controlling the project schedule  Ensuring the quality of the final result  Stakeholder Engagement Educate the stakeholders – to understand what the new ―systems‖ (to be) is designed to 18
  • 19. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Initiating You as a ERP Project Manager Must Have : 1. Interpersonal Skills  Leadership  Positive Attitude  Managing People –people skills(Good Listener, Coaching , Motivation, Influencing, Flexible)  Conflict Management  Team Building  Trust Building  Political and Cultural Awareness 2. Knowledge and Technical Skills (in ERP area Implementation)  Resourceful and Sense of Perspective  Business Process ( Insurance, Manufacturing, Trading, Banking etc)  ERP  Integration concept  Business and IT Alignment  IT Knowledge 3. Performance Skills  Management and Conceptual Skills (Planning, Organizing)  Business Skills (Business Communication, Negotiating, Marketing) Project managers accomplish his work through the project team and other stakeholders ―Buy-in‖ 19
  • 20. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation - Initiating . How ? By :  Creating and maintaining an environment -that is conducive-, and results in the accomplishment of meaningful project work. Source : Internet (www) Use your communication channel and tools, including social media 20
  • 21. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation - Initiating First Step Project Constraint © Rita Mulcahy (PMP Exam Prep, 2013) Project Team… must aware !!! Tools and Technique :  Expert Judgment (SME)  Facilitation Techniques (Brainstorming, Focus Group) Project Manager first Agenda:  Meeting with your Project Sponsor  Project Charter (Including / excluding OCM)  Acquire Key Team Members  Identify (preliminary engage) Key Stakeholder  Stakeholder List  Project Management Framework Explanation Who is your Project Sponsor 21
  • 22. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation - Initiating Project Charter - Why-kenapa proyek ini diperlukan dan penting ? - Tujuan dan target apa yang dikehendaki organisasi ? - Hitungaan cost-benefitnya bagaimana ? - High Level dari lingkup pekerjaan yang akan dikerjakan dalam proyek ini ? - Ditegaskan pula yang tidak menjadi lingkup pekerjaan dalam proyek ini : misalnya melakukan kustomisasi ERP Oracle Financials R 12.1, sesuai dengan aturan bisnis yang telah diterapkan pada dokumen Proses Bisnis yang telah disetujui sebelumnya - Siapa saja yang terlibat dalam proyek, struktur org.team - Apa yang boleh dan tidak boleh dikerjakan oleh team proyek - Aturan pokok yang menjadi dasar pelaksanaan proyek (regulasi) - Tujuan dari proyek harus dapat diukur (measurable). Misalnya untuk mempercepat proses pelaporan keuangan maks 2 hari setelah periode tutup buku berakhir - Jadwal pelaksanaan proyek (cukup milestonenya saja) - Tgl awal dan tanggal akhir jadwal proyek - Biaya yang diperlukan (total) - Constraint : faktor/hal yang membatasi pelaksanaan proyek - Assumptions : faktor /hal yang harus ada, dalam pencapaian tujuan proyek - Risk : Risiko berdasarkan analisa dokumen dan lingkungan proyek - Dependencies : Ketergantungan terhadap faktor lainnya (Server etc) 22
  • 23. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation - Initiating Stakeholders ? Stakeholders is an individual, group, or organization who may affect, be affected by, or perceive itself to be affected by a decision, activity, or outcome of a project. More about Stakeholders :  involved in the project or have interests that may be positively or negatively affected by the performance or completion of the project.  different stakeholders may have competing expectations that might create conflicts within the project.  may also influence the project, its deliverables, and the project team in order to achieve a set of outcomes that satisfy strategic business objectives or other needs. 23
  • 24. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation - Planning 2. Planning :  Plan the Work, Work the Plan As IS (Current Systems) 1.Current Business Process 2.Current Work Discipline/ regulation 3.Current Authority 4.Current Competency 5.Current Mindset 6.Current …………. 1. Automation 2. Real time Process 3. Real time Output 4. Discipline in Data Entry To BE (Future Systems) The Transition Phase Transition Agenda : Related to Project Management Process Related to Produce the Project Result (ERP Customization) Related to Transition Management (Organizational Change Management - OCM) 24
  • 25. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation - Planning Your Planning Approach Project Management ERP Implementation Management Organizational Change Management 25
  • 26. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation - Planning MAPPING THE WORKPLAN Project Management Process ERP Customization Process OCM Process Tools and Technique :  Expert Judgment (SME)  Facilitation Techniques (Brainstorming, Focus Group) 26
  • 27. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation - Planning A. Project Management  High Level Plan  Project Management Plan Integration, Scope, Time, Cost, Quality, HR, Communication, Risk, Procurement, Stakeholder Objective 1 : 1. How Implementation will execute : - Milestone - Key Deliverables (Deliverables Baseline) - Project Kick-off ? 2. How Change (Change Request) Management will be controlled 3. How Issue, Risk will be managed 4. How Communication will be managed  Stakeholders - Sponsors - Users (Dept. Head, Key Users)  Internal Project Team Objective 2 : 1. How Quality will be managed 2. How Your Project Team will be managed (developed) 3. How Cost (Budget) will be managed (controlled) 4. How Procurement will be managed How the team will execute, monitor, control, and close the project (PMBOK ® 5ed) 27
  • 28. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation - Planning Milestone example : Slide - pendukung Initiating Planning Executing Start Milestone 3 (BP Freeze Agreed) Milestone 4 (ERP – COTS Customization Completed ) Deliverable 2.1 (Module-_1 Internal Testing Completed) Milestone 1 (Project Charter Agreed ) End Closing Milestone 5 (Lesson Learned) Milestone 2 (Project Management Plan Completed) Milestone : represent a moment in time with zero duration 28
  • 29. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project Management Plan Example form : Process Tools and Techniques : Menjelaskan tools dan teknis khusus yang akan dipergunakan untuk masing-masing proses. misalnya : sofware tertentu (PMIS, costing software or method) Project Management and Tailoring Decisions : Keputusan, kebijakan, pendekatan (approach) serta proses khusus (specific) yang dipergunakan dalam setiap phase proyek misalnya : Pendekatan yang ditempuh dalam penanganan risiko, prinsip dalam pengelolaan biaya dll. 29
  • 30. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project Management Plan Detailing the Project Management Plan : Main Flow Project Management and Tailoring Decisions : Keputusan, kebijakan, pendekatan (approach) serta proses khusus (specific) yang dipergunakan dalam setiap phase proyek misalnya : Pendekatan yang ditempuh dalam penanganan risiko, prinsip dalam pengelolaan biaya dll. 30
  • 31. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning-Project Scope Management Plan Project Requirements : Tools and Technique :  Interviews  Brainstorming  Focus Group  Observations  Context Diagram 1.Business Requirements 1. Traceability 2. Business Rule 3. Audit trail 2.Stakeholder Requirements 1. Organization Structure 2. Connection to others Systems (Internal others Systems and external systems—i.e. E-Banking) 3. OCM – stakeholder communication and reporting requirements 3.Solution Requirements 1. Functional :  processes, data, and interactions with the ERP 2. Nonfunctional requirements :  reliability, security, performance, safety, level of service, supportability, retention/purge, etc 4.Transition Requirements : (“as-is” to “to-be”) 1. Data conversion requirements, migration 2. Training requirements 5.Project Requirements 1. Levels of service, performance, safety, compliance, etc 2. Acceptance criteria 6.Quality Requirements :  capture any condition or criteria needed to validate the successful completion of a project deliverable or fulfillment of other project requirements 31
  • 32. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project Scope Management Plan Scope Management Plan :  Define Scope :  Project Scope Statement Menjelaskan karakteristik produk, service atau result. Informasi ini bersifat progressively elaborated dari penejelasan proyek dan dokumentasi requirements Identifikasi deliverable (produk dan proyek) yang di setujui bersama dengan stakeholders yang berkepentingan (especially customer/sponsor), termasuk laporan pelaksanaan pengelolaan proyek dan dokumentasinya. Kriteria yang diperlukan dalam persetujuan penerimaan deliverable oleh stakeholder. Kriteria ini dapat dibuat untuk keseluruhan proyek untuk setiap komponen deliverable Menjelaskan apa saja yang berada diluar scope proyek. Menjelaskan faktor/hal-hal yang membatasi team proyek dalam pelaksanaan proyek guna mencapai tujuan proyek (due dates yang sangat singkat, tingkat kesulitan teknologi yang dipergunakan dsbnya) Asumsi tentang deliverable, resources, estimate dan aspek lain dari proyek, yang diharapkan menjadi nyata, namun belum divalidasi (Training ERP dilakukan setelah Server Training yang dibeli dari pihak ketiga selesai di instal) Tools and Technique :  Product Analysis  Expert Judgment  Brainstorming 32
  • 33. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning-Project Scope Management Plan Project WBS (Work Breakdown Structure ): Create WBS !!  Tips in Creating WBS  Create WBS :  phase  Stage …Work Package (a) WBS example: Structure (summary level) (b) WBS example : Coding Scheme or List (using Software – MS Project) Identified : Activities (resources), Duration (Hour) , Cost, (estimated) 33
  • 34. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning -Project Schedule Management Plan Schedule Management (Time) : Determine Activities, Resources and Duration  Calendar Kerja Perusahaan, Jadwal Key Stakeholder –yang tidak dapat diubah)  Constraint : - Due Date ?  Activities : masing-masing kegiatan 34
  • 35. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project Cost Management Plan Cost Management Plan:  Menentukan Budget Proyek Source :© Rita Mulcahy (PMP Exam Prep, 2013) Project Cost From WBS 35
  • 36. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project Communication Management Plan Communication Plan : Communication requirements analysis :  Number of Potential communication channels : n(n-1)/2,  n=number of Stakeholder  Stakeholder : location, internal/external, department, role and responsibilities in project, etc Communication Technology Factor Choice: (The methods used to transfer information among project stakeholders)  Urgency of the need for information (urgency, frequency, format)  Availability of technology  Ease of Use  Project Environment (location—time zone– of stakeholders), culture, languages)  Sensitivity and confidentially of the information (confidential, security) 36
  • 37. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project Communication Management Plan Communication Plan : (slide pendukung) 37
  • 38. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project Risk Management Plan Plan Risk Management Source © Sabaruddin de AB (ERP PM Training Course , 2015) 38
  • 39. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project Risk Management Plan Plan Risk Management What ? is the process of defining how to conduct risk management activities for a project. It ensures that the degree, type, and visibility of risk management are commensurate with both the risks and the importance of the project to the organization. Definition : Project risk is an uncertain event or condition that, if it occurs, has a positive or negative effect on one or more project objectives such as scope, schedule, cost, and quality. How ? Disebabkan karena pola penanganan risiko yang memunculkan opportunity untuk memberikan hasil( results )yang menguntungkan Note :  Positive Risk : Opportunity (Exploit, Enhance, Share, Accept)  Negative Risk : Threats (Avoid, Mitigate, Transfer, Accept) Source © PMI Guide 5th Ed. 39
  • 40. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project Risk Management Plan Note : (untuk setiap item risk) 1. Owner of risk response: (penangungjawab risiko)  melakukan tindakan sesuai mekanisme penanganan risiko--selalu monitor dan evaluasi proses-proses yang menjadi sumber timbulnya risiko (sesuai risk register updates) 2. Risk mechanism : mekanisme penanganan risiko (response plan)  5M  Monitor, observasi dan dokumentasi data  Menelaah (analisis) dan evaluasi gejala serta menentukan tindakan  Melakukan tindakan-tanggap pertama--mitigate, avoid dll yang dibuat berdasarkan hasil qualitative dan atau quantitative– (Response Plan)  Melakukan tindakan kedua (Contingency Plan)—bila response plan tidak bekerja  Melakukan tindakan ketiga (Fallback Plan)—bila contingency plan tidak bekerja Risk Attitude : (bagaimana para stakeholder menyikapi risiko)  Risk appetite : which is the degree of uncertainty an entity is willing to take on in anticipation of a reward. (untuk tingkat tertentu mau mengambil—menerima-- risiko dengan mempertimbangkan hasil baliknya)  Risk tolerance : which is the degree, amount, or volume of risk that an organization or individual will withstand. (untuk tingkat tertentu menerima akibat dari risiko yang terjadi)  Risk threshold : which refers to measures along the level of uncertainty or the level of impact at which a stakeholder may have a specific interest.  Risk happened < risk threshold  will accept the risk  Risk happened > risk threshold  will not tolerate the risk. 40
  • 41. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project Risk Management Plan Risk Management Plan : (and ISSUE) Risk Treatment (known – proactively manage) PLAN A Risk Contingency (known - can not manage) PLAN B Risk Fallback (unknown risk- suddenly happened) PLAN C FOCUS : ELIMINATE and EXPLOIT Treatment Plan : - Known-known risk - Primary risk (Based-on Risk Register) Positive Risk (Opportunities): - Exploit, Enhance, Share Negative Risk (Threats): - Avoid, Transfer FOCUS : MITIGATE Contingency Plan : - If Risk Response Plan not work - Risk that appear after Treatment execution - Known-Unknown risk Positive Risk (Opportunities): - Accept Negative Risk (Threats): - Mitigate, Accept FOCUS : SAVING THE REST Fallback Plan : - If Contingency plan not work - Residual Risk - Unknown-Unknown risk Source © Sabaruddin de AB (ERP PM Training Course , 2015) Contingent Response Strategies 41
  • 42. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project Quality Management Plan Plan Quality Management What ? Is the process of identifying quality requirements and/or standards for the project and its deliverables, and documenting how the project will demonstrate compliance with relevant quality requirements. Provide guidance and direction on how quality will be managed and validated throughout the project (addresses the management of the project and the deliverables of the project) Basic Concept :  Quality as a delivered performance or result is ―the degree to which a set of inherent characteristics (of project) fulfill requirements‖ (ISO 9000)  Approaches seek to minimize variation and to deliver results that meet defined requirements  Customer Satisfaction, Prevention over Inspection, Continuous Improvement (PDCA), Management Responsibility, Cost of Quality (conformance and Non-conformance) Failure cost =cost of poor quality For project, project management, product or services © PMI, PMBOK Guide 5th Edition 42
  • 43. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project Quality Management Plan Plan Quality Management Output :  Quality Management Plan : Describes how the organization’s quality policies will be implemented, and how the project management team plans to meet the quality requirements set for the project  Process Improvement Plan : Menjelaskan secara rinci tahapan dalam analisis manajemen proyek, pengembangan produk, maupun proses lainnya yang terkait guna identifikasi dan peningkatan kualitas pelaksanaannya  Quality checklist : daftar item yang akan di inspeksi atau langkah2 pengujian kulaitas yang harus dilaksanakan. dimaksudkan untuk membantu verifikasi tindakan yang diperlukan telah dilakukan atau item tertentu telah dimasukkan  Quality metrics : daftar item (attribut) kualitas project atau produk, ukuran kualitas dan cara (proses) setiap item tersebut diukur  ID : WBS ID  Item : penjelasan WBS  Metric : ukuran kualitas  Measurement : cara mengukur kualitas 1. Module_1 Jumlah Bug 1. Internal Testing - Tidak ada Bug major - Tidak ada Break Out - Bug minor < 5 Kesesuaian detil Laporan - Kalkulasi formula - Logika decision 43
  • 44. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project HR Management Plan What ? is the process of identifying and documenting project roles, responsibilities, required skills, reporting relationships, and creating a staffing management plan. it establishes project roles and responsibilities, project organization charts, and the staffing management plan including the timetable for staff acquisition and release. How ? Glossary : Organization charts and position descriptions :  struktur organisasi yang sesuai dapat dipilih untuk struktur organisasi proyek Networking : Formal and informal interaction with others in an organization, industry, or professional environment.  proyek manager dapat menggunakannya guna mendapatkan data, informasi dan personal dengan kompetensi yang diharapkan. Organizational theory : Teori organisasi, termasuk didalamnya teori Herzberg, Abraham Maslow (Hierarchy of Needs) misalnya, dapat dipergunakan dalam merancang HR management plan The Pyramid : Hierarchy of Needs Plan HR Management © PMI, PMBOK Guide 5th Edition 44
  • 45. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project HR Management Plan. A Project : Key Players Customer (Project Owner) Stakeholders Supplier/ Vendors/ Seller Sponsor Project Manager Key Team Member Team Member © Bruce, Andy and Langdon, Ken, Project Management 45
  • 46. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project HR Management Plan RACI Chart - Responsible : Yang melakukan pekerjaan (doer) - Accountable : Yang bertanggungjawab pada hasil pekerjaan (punya hak veto) Yes or No - Consult : Konsultasi kepada yang bersangkutan sebelum mengambil keputusan  Pendukung tindakan - Inform : Yang selalu harus diinformasikan setelah keputusan diambil atau pekerjaan dilakukan (cccopy carbon) © PMI, PMBOK Guide 5th Edition 46
  • 47. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project Procurement Management Plan Plan Procurement Management What ? is the process of documenting project procurement decisions, specifying the approach, and identifying potential sellers. It determines whether to acquire outside support, and if so, what to acquire, how to acquire it, how much is needed, and when to acquire it. How ? Glossary :  Make-or-buy analysis : a general management technique used to determine whether particular work can best be accomplished by the project team or should be purchased from outside sources  Market research : includes examination of industry and specific vendor capabilities © PMI, PMBOK Guide 5th Edition 47
  • 48. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project Stakeholder Management Plan Plan Stakeholder Management What ? Is the process of developing appropriate management strategies to effectively engage stakeholders throughout the project life cycle, based on the analysis of their needs, interests, and potential impact on project success. Why ? : as Project Manager you need support from all Stakeholder (and also you have to satisfy their expectation in based on the project charter) How ? Engagement level of the stakeholders : • Unaware : Unaware of project and potential impacts. • Resistant : Aware of project and potential impacts and resistant to change. • Neutral : Aware of project yet neither supportive nor resistant. • Supportive : Aware of project and potential impacts and supportive to change. • Leading : Aware of project and potential impacts and actively engaged in ensuring the project is a success. © PMI, PMBOK Guide 5th Edition 48
  • 49. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Project Stakeholder Management Plan Stakeholder Management Plan Stakeholder engagement matrix : Aware Unaware of project and potential impacts 49
  • 50. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – ERP Customization Process Management B. ERP Customization Process Project Management Process ERP Customization Process OCM Process B.1 ERP Vendor Selection Plan 1. ERP Features and Vendor Qualification Requirements  Using Business Case 2. Benchmarking  To get the realistic implementation (you need it, if the first time using ERP) 3. Create Vendor Selection Plan 3.1. ERP Vendor Gathering Qualification Information (Receiving Vendor Proposal)Conference 3.2. ERP Vendor Contest (Many  10  5  2-3  1 )  Fit and Gap Analysis ( Vendor Presentation result Vs B.1.1) (Time, Scope, Cost, Quality)  Contract Guarantee ( Vendor Team Development Issue ?) Project Charter 1. Objective/goals ERP Implementation 2. Process Business and area/function to improve 50
  • 51. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – ERP Customization Process B.2 ERP Vendor Selection 1. ERP Vendor Presentation (some check list and table should be prepared)  How the Business Process  fit with ERP features  Focus to how the area and function (should be improved) would be completely done by ERP Package  Another requirement from ERP Vendor (that would be impacted the STCQ)  ERP Implementation/customization plan (stage)  Check List How CRP (Conference Room Pilot) would be done ?  fit and gap in more detail  CRP I  Vendor presentation on Solving a business case (small case)  solved ?  How the customization would be done How testing would be done  How Project Documentation and Training support would be done 2. ERP and Vendor Fit Report (Pros – Cons)  Business Requirements Vs ERP Vendor Presentation Result  Another Cost, Issue, Constraint etc. ? 51
  • 52. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Planning – Organizational Change Management C. Organizational Change Management C.1. Develop Organizational Change Management and Communication Plan 1. Impact of ERP Implementation in Organization : Organization Structure ?  RACI, Headcount , FTE (Full Time Employee)  New Function, New Role and Responsibilities , New SOP HR Capability (Users and another stakeholders) ?  Knowledge and Skills A New way of work  Integration 2. Structure approach Top-down and Bottom-Up  Top Management Priority (Top Down)  Key User and User Involvement (Bottom Up )  Engagement , true participation 3. HR Development User benefit  Incentive  Promotion  Others Employee benefit Individual Group Organisasi 52
  • 53. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation -Planning – Organizational Change Management C.2 Executing the OCM and Communication Plan 1. Resistance  Elizabeth Kubler-Ross Change Curve (On Death and Dying, Macmillan, NY, 1969) 53
  • 54. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation-Planning – Organizational Change Management Example Case : 54
  • 56. ©Sabaruddinde AB Perlunya IT DepartemenProject Trouble? Day to day in Project Executing…. Source : Internet (www) 56
  • 57. ©Sabaruddinde AB 3. Executing Perlunya IT DepartemenIII. Implementation - Executing Tools and Technique :  Coordination (Interpersonal Skills  Communication (Interpersonal Skills)  Field Visit (Genci Genbutsu)  Meeting  Direct and Manage Project Work (as per Project Schedule Baseline) 1. Project Team Management 2. ERP Customization Plan and Execution 3. Conduct Procurement 4. Manage Stakeholder Engagement  Perform Quality Assurance  Manage Communication  Monitor and Control Project Work 1. Integrated Change Control 2. Control and Validate Scope 3. Control Schedule 4. Control Cost 5. Control Quality 6. Control Communication 7. Control Risk 8. Control Procurement 9. Control Stakeholder Engagement 4. Monitoring and Controlling 57
  • 58. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Executing – Project Team Management 1. Project Team Management  Work Management  Daily Activity  Team Performance Assessment  Work (project schedule) Monitoring and Controlling  Daily Activity Report  Work Package Progress Report (Weekly and Monthly)  Team Performance Report (Monthly)  Schedule Realization (Plan Vs Actual)  Develop Project Team Performing (multi-style approach)  Observation and Assessment  Coaching  Short – Training Tools and Technique :  Interpersonal Skills  Observation  genci genbutsu  Direct and Manage Project Work (as per Project Schedule Baseline) 1. Project Team Management 2. ERP Customization Plan and Execution 3. Conduct Procurement 4. Manage Stakeholder Engagement 58
  • 59. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation – Executing – Project Team Performance Develop Project Team Performing  Performing Tools Coaching Short-Training “Fergusson hair dryer” “Mourinho motivation style” Active (+) Passive (-) Forming Performing(+) Norming Storming (-) Adjourning TeamWorkPerformance Time Information and Communication : - Intensive Communication - Motivation - Individual approach - Trust Building - Engagement Managing and control Work : - Target List - Full Support - Feed Back “Mourinho motivation style” Tools and Technique :  Coaching  Short-Training  Treatment (Ferguson vs Mourinho) “Ferguson hair dryer” 59
  • 60. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation - Executing 2. ERP Customization Plan and Execution  Direct and Manage Project Work (as per Project Schedule Baseline) 1. Project Team Management 2. ERP Customization Plan and Execution 3. Conduct Procurement 4. Manage Stakeholder Engagement CRP (Conference Room Pilot ) – II, … 60  ERP Customization Plan  Testing of Customization Design  Fit to Requirements  Approval  Execution  Coding (Customization)  Testing in Coding phase (function test, unit test)  After Coding Testing (module test , integration test, system test)  UAT (User Acceptance Test) / Scenario Test  as systems requirements testing  Training Manual Preparation  UAT (How UAT will be conduct )  team and executing plan (training, familiarization)
  • 61. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation - Executing 3. Conduct Procurement  Provide Technical Specification Requirements  Vendor /Supplier Selection  Interview of Supplier Performance  Procurement Schedule Monitoring  Receiving Approval 4. Manage Stakeholder Engagement Issue (Rise , Monitoring and Control )  Issue Register  RISK  Risk Register  Progress Report  Talk with Data and Information  Highlight / Flash Report  to Focus on Stakeholders Responsibilities  Direct and Manage Project Work (as per Project Schedule Baseline) 1. Project Team Management 2. ERP Customization Plan and Execution 3. Conduct Procurement 4. Manage Stakeholder Engagement Feed to Monitoring and Controlling Process 61

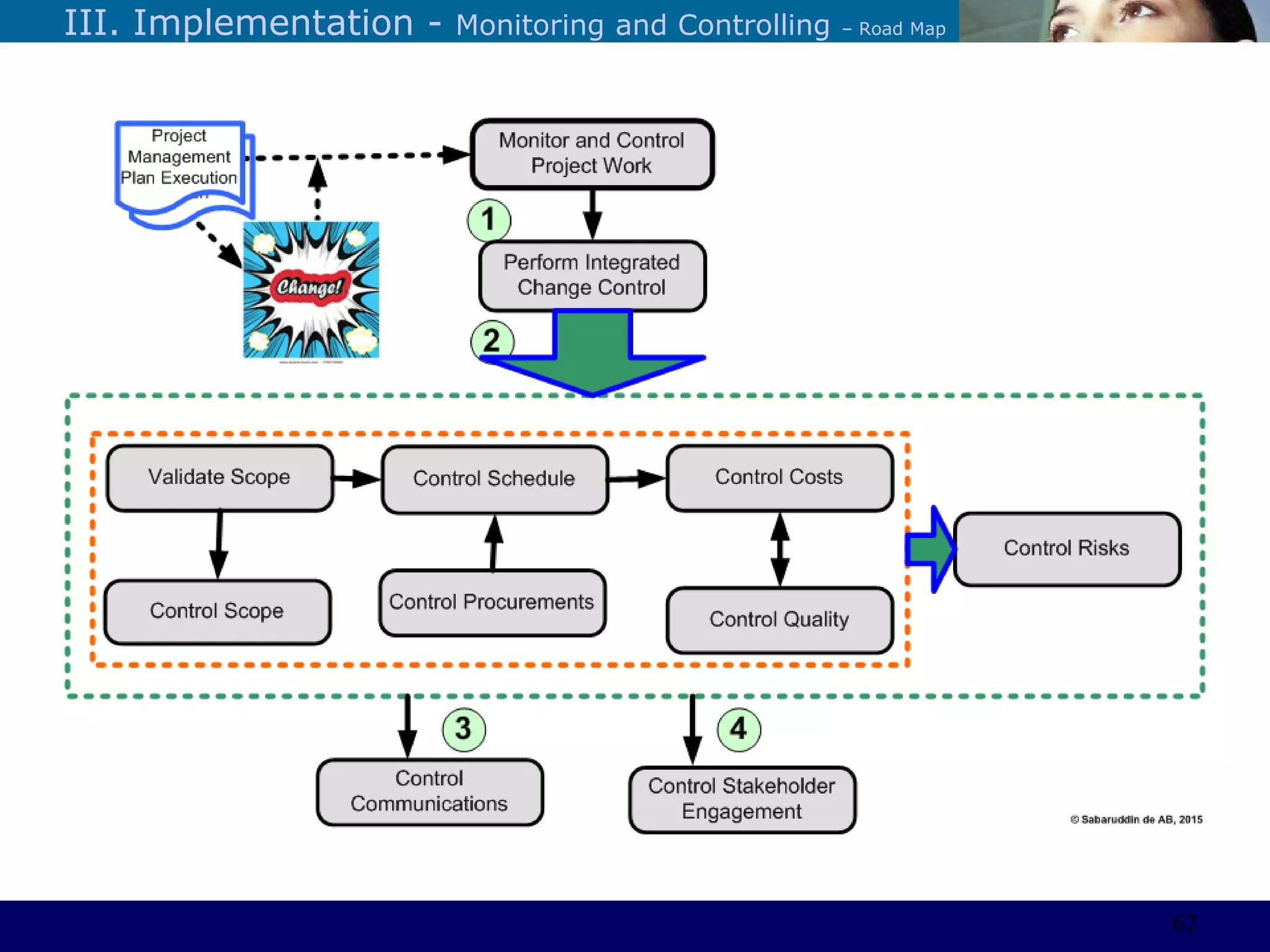

  • 62. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation - Monitoring and Controlling – Road Map 62
  • 63. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation - Monitoring and Controlling – Approach Project Charter 63
  • 64. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation- Monitoring and Controlling - Action 4. Monitoring and Controlling (prepare your check list for STCQCRPS) 1. Monitoring  Schedule :  ERP Customization Schedule (absence, work package)  Team Performance Report  Product/deliverables/Customization Result  On-time ?  Cost  Improvement Process (Quality of Deliverables/Product)  Rework  Repair 2. Controlling  Project Constraint  Project Change Management (in SCOPE ?)  Change Request Procedure  Change Approval Procedure  Board of Change (BOC)  Scope Creep :  Preliminary Business Case ? Project Requirements ?  Control Budget, Quality, Communication, Risk and Issue  Manage Your Stakeholder Engagement  Personal Absence (as scheduled):  Team Development  Vendor side  Key Users/Users (in information gathering, regular meeting , CRP, etc)  Key Stakeholders / business process owner (in requirements approving)  Procurement Process (Server and DBMS purchasing, DBMS Installation ?)  Environment and organizational behavior  Potential Issue ?  Manage  to not become a Risk ALWAYS CHECK within YOUR PROJECT SCHEDULE  Will be impacted Time, Cost, Quality, Communication, Risk, HR, Cost,  Schedule 64
  • 65. ©Sabaruddinde AB Perlunya IT DepartemenIII. Implementation - Closing 5. Closing 1. Document Preparation  Project Management Document  Product Life Cycle Document  OCM Document  Lesson-Learned Document  Opportunity Proposal (by Project Manager) 2. Project Closing  Project Closing Meeting  Procurement (any issue about payment ?)  Project Team meeting  Internal Team  Promotion ? 65
  • 66. ©Sabaruddinde AB Perlunya IT DepartemenIV. Deployment (Roll Out) and Training Post Implementation Process - I Project Management Process ERP Customization Process OCM Process Deployment (Roll Out) and Training 1.Deployment Plan executing 2.Training Plan executing (TOT) - Flow Process(“as is“ vs “to Be”) - Hands on - Manual operation (as preliminary SOP) 3. User Training - Flow process, Hands on - Attachment Training - Handholding/baby sitting (pendampingan) - FamiliarizationDeployment and Training Plan :  Deployment Plan :  DEPLOY TEAM  Pilot vs Big Bang ?  Replace vs Parallel  Transaction Cut-Off Plan  Number of Site  Prioritization(Effect Vs Feasibility)  Infrastructure (Networking, Internet Connection)  INFRA TEAM  Team Readiness Preparation Plan (knowledge, skills and experiences)  Training Plan :  TRAINING TEAM  Number of user (all level)  Role and Responsibilities (new org. structure ?)  Training Approach and Process: ( TNA, TR, Method, Model, Length, TOT, etc) • New way of work (Cara kerja baru ) • Integration concept • How to operate  RBT (role based training) • Technical Operation Training  Develop ITSM Milestone (based on ITIL ?)  Help Desk 66
  • 67. ©Sabaruddinde AB Perlunya IT DepartemenV. Stabilizing and Performance Monitoring Post Implementation Process - II Project Management Process OCM Process Stabilizing and Monitoring Performance 1.To ensure user using the application (Hand holding/ Baby sitting ) 2. Using SOP (would be updated for Final SOP in Hand over) 3. To ensure or systems trouble would be handled (troubleshooting)  Implementer stay on backup position 4. Performance To do list, and Check List (Connection monitoring, etc) 5. Routine activities (e.g. backup schedule, Log book (as source of Lesson learned, etc) 6. Establishing Help Desk (as ITSM preliminary structure) Deployment(roll Out)andTraining Stabilizing and Monitoring Performance Plan :  Monitoring Plan  Internet Connection, Error and Bug  Help Desk Operation (all cases, Trainer as problem solver, Infra team as trouble shooting ?)  Server Processing (connection time, trx time, session time ?)  Stabilizing Plan :  Bandwidth (additional ?), VPN upgrade ?, Cloud Agreement?  SOP Drafted  Performance Standard (measurement Level)  Transaction (entry time, manual error, etc)  To do List and Check List  Develop Task Force Team (mainly from Deployment and Training Team)  for executing monitoring and stabilizing plan  ITSM Establishing  Help Desk structure and SOP completed  IT Service Management (ITSM) Mechanism and Procedure development  OCM Program (back up the situation and Issue) Issue Management Change Management Program  for especially situation 67 ERP Customization Process
  • 68. ©Sabaruddinde AB Perlunya IT DepartemenVI. Hand-Over to Operation (Benefit Monitoring) Post Implementation Process - III Project Management Process ERP Customization Process OCM Process Hand –Over to Operation (Benefit Monitoring) 1. Final ERP SOP 2. ITSM and Final SOP  Help Desk  Accident and Incident Management  Other IT Services 3.Benefit Status List Report 4.Lesson-learned Document Deployment(Roll Out)andTraining Stabilizingand Performance Monitoring Hand-Over to Operation Plan :  Draft SOP (ERP systems) Updated  Benefit Realization List  from Project Requirements (project Scope Plan)  Completed ITSM (inc. Help Desk)  Structure and Personnel  ITSM SOP  Lesson-learned Updated 68
  • 69. ©Sabaruddinde AB Perlunya IT Departemen. Source : Internet (www) 69
  • 71. ©Sabaruddinde AB Appendix (All appendix take from IT PM and ERP PM Training Course by BAP Consulting ) 20. Plan Risk Management (Risk - 11.1) metode atau pendekatan yang ditempuh dalam mengelola risiko proyek. Apa dan bagaimana tahapan prosesnya, dalam kondisi apa, toolsnya (RBS-Risk Breakdown Structure), tekniknya (interview, delphi technique, etc), dan sumber datanya. peran dan tanggungjawab apas aja yang diperlukan dalam manajemen risiko bagaimana setiap aktifitas manajemen risiko di anggarkan pedoman untuk penentuan, pengukuran dan alokasi anggaran(budget) dan jadwal contingency pengelompokkan risiko. Plan Risk Management 71
  • 72. ©Sabaruddinde AB Perlunya IT DepartemenAppendix – Risk Management Plan Risk Management Identifikasi tingkat toleransi risiko, stakeholdernya dan tujuannya masing-masing Frekuensi dalam melakukan aktifitas manajemen risiko dan waktu pelaksanaannya Bagaimana aktifitas manajemen risiko di dokumentasikan, di lacak, dan di audit  Bagaimana dampak terjadinya risiko didefinisikan dan diukur, untuk setiap aktifitas maupun secara keseluruhan, contoh : • Very High : budget overrun > 15%, • High : overrun 10- 15%, • Medium : overrun 7-10%, • Low : overrun 3-7%, • Very Low : overrun 1- 3%  bagaimana probabilitas risiko di definisikan dan diukur (umumnya mempergunakan skala tertentu) contoh : • Very High : >80%, • High : 60 – 80%, • Medium : 40 – 60%, • Low : 20 – 40%, • Very Low : 1- 20% 72
  • 73. ©Sabaruddinde AB Perlunya IT DepartemenAppendix – Risk Management Plan Risk Management kombinasi dari probabilitas dan dampak yang mengindikasikan high risk, medium risk dan low risk 73
  • 74. ©Sabaruddinde AB Perlunya IT DepartemenAppendix – Risk Management Plan Risk Responses Slide Pendukung : Risk Data Sheet  Dokumentasi setiap item risiko 74
