PUBLIC
SAP Activate 2002
February 11, 2020
Deploying SAP S/4HANA Cloud
with SAP Activate
2PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ

Agenda
Introduction to Cloud
Trial
Setup and Enablement
Fit-to-Standard
Scope and Configure
Migration, Integrate, Extend and Test
Deploy
Operate, Monitor, and Support
SAP Activate Apps and Enablement
The Road to SAP S/4HANA Cloud with SAP Activate
3PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ

SAP S/4HANA Deployment Options
SAP S/4HANA
Designed for enterprises across industries
that need a deep and broad level of
functionality combined with a high degree
of flexibility in customization
SAP S/4HANA CLOUD
Designed for enterprises that need a
standardized cloud offering primarily covering
the core business scenarios of an enterprise or
specific business scenarios of lines of business
in industries - combined with a fast innovation
cycle (quarterly)
CONTROL & FLEXIBILITY
EFFICIENCY
HYBRID SCENARIOS
Combining on-premise and cloud solutions for unprecedented IT
flexibility and accelerated business innovation.
4PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ

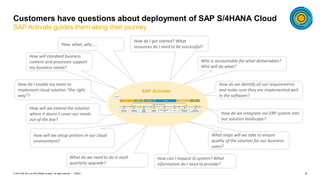

Customers have questions about deployment of SAP S/4HANA Cloud
SAP Activate guides them along their journey
How do we integrate our ERP system into
our solution landscape?
Who is accountable for what deliverables?
Who will do what?
How will standard business
content and processes support
my business needs?
How do I enable my team to
implement cloud solution “the right
way”?
How do I get started? What
resources do I need to be successful?
How will we setup printers in our cloud
environment?
How will we extend the solution
where it doesn’t cover our needs
out of the box?
How do we identify all our requirements
and make sure they are implemented well
in the software?
How can I request Q-system? What
information do I need to provide?
What steps will we take to ensure
quality of the solution for our business
users?
What do we need to do in each
quarterly upgrade?
SAP Activate
How, what, why ….
5PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Launch quickly and efficiently,
standardized for integration
Self-service to expand capabilities when,
where, and how you choose
Business Processes
Delivered
Ready to Run
Clear Methodology for
Adoption and
Extensibility
Apps for Adoption
and Extensibility
Business-Driven Innovation with SAP Activate
Self-service configuration through a clear deployment
methodology of solution-specific practices, in a
standardized environment Speed of Innovation Greater Productivity
Business ImpactGrowth & Scalability
Innovation as a Service is how your business deploys new capabilities, when and how you choose,
to build a sustained competitive advantage
SAP Activate

6PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Best Practices
SAP Cloud ALM
Methodology
Agile implementation methodology with role-based detailed implementation tasks,
available as content in the implementation portal and in the Roadmap Viewer.
RunDeployRealizeExploreDiscover Prepare
Innovate,
Operate, Support
Onboard and
Deploy
Scope and
Configure
Migrate, Integrate,
Test
Fit-to-
Standard
Analysis
Extend
Setup and
Enablement
Discovery
Assessment
Continuous innovation
Ready-to-use business processes, available in all SAP S/4HANA Cloud tenants. Start the
scoping and the configuration with standard processes.
Guided implementation with flexible task and content management leveraging best-
practices content and methodology content combined to accelerate the implementation.
Deployment experience with SAP Activate

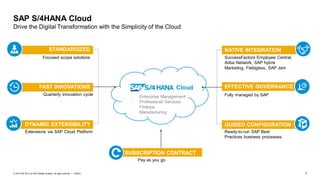

7PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
EFFECTIVE GOVERNANCE
STANDARDIZED
FAST INNOVATIONS
DYNAMIC EXTENSIBILITY GUIDED CONFIGURATION
NATIVE INTEGRATION
Focused scope solutions
Quarterly innovation cycle
Extensions via SAP Cloud Platform
Fully managed by SAP
SuccessFactors Employee Central,
Ariba Network, SAP hybris
Marketing, Fieldglass, SAP Jam
Ready-to-run SAP Best
Practices business processes
- Enterprise Management
- Professional Services
- Finance
- Manufacturing
SUBSCRIPTION CONTRACT
Pay as you go
Cloud
SAP S/4HANA Cloud
Drive the Digital Transformation with the Simplicity of the Cloud
8PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Activate Implementation Methodology
How Do SAP Cloud Implementation Projects Differ?
Standardized Solution
Focused scope solutions that allow tailoring to fit the customer’s business and reduce complexity
Roles
Customer owns many more tasks of a
public cloud implementation such as data
migration, testing and change management
Handover to Support
Cloud customers are handed over to SAP
Cloud Support for long term system
management
Project Timeline
Public cloud project is initiated
immediately following contract
signature with go live in 2 to 25 weeks
System Landscape
Public cloud solutions typically use
only one test system and a production
system
Innovation
Upgrades to public cloud solutions are
automatically applied by SAP every
three months
9PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ

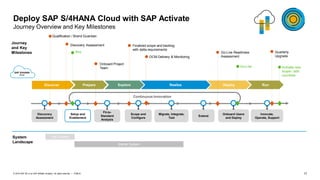

RunDeployRealizeExploreDiscover Prepare
Continuous Innovation

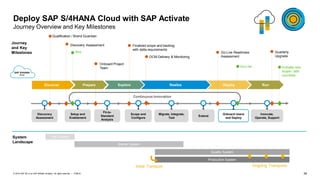

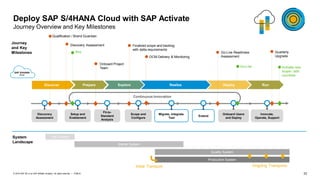

Deploy SAP S/4HANA Cloud with SAP Activate
Journey Overview and Key Milestones
Journey
and Key
Milestones
Qualification / Brand Guardian
Discovery Assessment
Onboard Project
Team
Finalized scope and backlog
with delta requirements
Go-Live Readiness
Assessment
Buy
Go-Live
Innovate,
Operate, Support
Onboard Users
and Deploy
Scope and
Configure
Migrate, Integrate,
Test
Fit-to-
Standard
Analysis
Extend
Setup and
Enablement
Discovery
Assessment
Quarterly
Upgrade
Activate new
scope / add
countries
SAP S/4HANA
Cloud
OCM Delivery & Monitoring
Quality System
Production System
System
Landscape
* Provisioned and managed by SAP, limited use license.
Initial Transport Ongoing Transports
Starter System
Trial System
10PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ

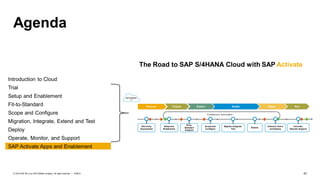

Agenda
Introduction to Cloud
Trial
Setup and Enablement
Fit-to-Standard
Scope and Configure
Migration, Integrate, Extend and Test
Deploy
Operate, Monitor, and Support
SAP Activate Apps and Enablement
The Road to SAP S/4HANA Cloud with SAP Activate
11PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
RunDeployRealizeExploreDiscover Prepare
Continuous Innovation
Deploy SAP S/4HANA Cloud with SAP Activate
Journey Overview and Key Milestones
Journey
and Key
Milestones
Qualification / Brand Guardian
Discovery Assessment
Onboard Project
Team
Finalized scope and backlog
with delta requirements
Go-Live Readiness
Assessment
Buy
Go-Live
Innovate,
Operate, Support
Onboard Users
and Deploy
Scope and
Configure
Migrate, Integrate,
Test
Fit-to-
Standard
Analysis
Extend
Setup and
Enablement
Discovery
Assessment
Quarterly
Upgrade
Activate new
scope / add
countries
SAP S/4HANA
Cloud
OCM Delivery & Monitoring
System
Landscape
* Provisioned and managed by SAP, limited use license.
Trial System
12PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ

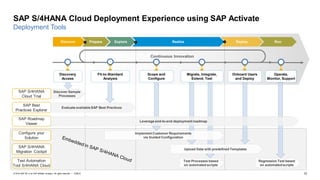

Discover Sample
Processes
SAP S/4HANA
Cloud Trial
SAP Best
Practices Explorer
RunDeployRealizeExploreDiscover Prepare
SAP S/4HANA Cloud Deployment Experience using SAP Activate
Deployment Tools
Test Processes based
on automated scripts
Configure your
Solution
SAP S/4HANA
Migration Cockpit
Test Automation
Tool S/4HANA Cloud
SAP Roadmap
Viewer
Discovery
Access
Operate,
Monitor, Support
Fit-to-Standard
Analysis
Scope and
Configure
Migrate, Integrate,
Extend, Test
Continuous Innovation
Regression Test based
on automated scripts
Operate,
Monitor, Support
Onboard Users
and Deploy
Implement Customer Requirements
via Guided Configuration
Upload Data with predefined Templates
Leverage end-to-end deployment roadmap
Evaluate available SAP Best Practices
13PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP S/4HANA Cloud (14 days)
SAP S/4HANA Trial System
Access Trial Edition:
http://www.sap.com/s4hana-trial
Web
SAP S/4HANA Cloud
Instantly access fully activated business processes with sample
data and organization structure. Follow guided tours to learn
about SAP S/4HANA Cloud.
Browse, view and download SAP Best Practices content. View
SAP Activate methodology roadmap online.
SAP Best Practices
Explorer
Discover SAP Best Practices
process content
SAP Roadmap Viewer
Discover methodology in the
form of an S/4HANA roadmap
SAP S/4HANA
Discover SAP Best Practices
processes in the starter system
Test Drive SAP Trial System & Explore SAP Activate
Discover Processes and Functions prior to Implementation
Experience Trial
14PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Analytics Cloud
SAP Business
One Cloud
SAP Hybris Revenue
Cloud
SAP Asset Intelligence Network
SAP Predictive
Maintenance
and Service
SAP Best Practices for Integration of S/4HANA Cloud
Dedicated capabilities reflect
market buying behavior via
LOB/Industry
Recommendations of
specific functionality
delivered in the cloud for
ease of adoption
Pre-configured scenarios to
drive Economies of Scale and
standardization
Intelligent
core
SAP Cloud for
Customer
16PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Digital Discovery Assessment
Assessment of Solution Scope
Document and capture project scope, through the SAP Digital
Discovery, to generate a scoping report. The report will be used as a
project scoping reference during the phases of the Implementation.
SAP Digital Discovery Assessment:
• https://sap.com/s4hanacloud-discovery
Benefits:
• Provides clear visibility and insight into the current
SAP Best Practices scope items
• Centralize documentation and validation of integration
and extensibility items of SAP and non-SAP solutions
within the customer’s landscape
• Help in documenting additional requirements identified
in the customer’s landscape
• Generate a detailed report, that is used to validate
integrations and outstanding questions that was
captured during the SAP Digital Discovery Process
Access the Digital Discovery Assessment
17PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
RunDeployRealizeExploreDiscover Prepare
Continuous Innovation
Deploy SAP S/4HANA Cloud with SAP Activate
Journey Overview and Key Milestones
Journey
and Key
Milestones
Qualification / Brand Guardian
Discovery Assessment
Onboard Project
Team
Finalized scope and backlog
with delta requirements
Go-Live Readiness
Assessment
Buy
Go-Live
Innovate,
Operate, Support
Onboard Users
and Deploy
Scope and
Configure
Migrate, Integrate,
Test
Fit-to-
Standard
Analysis
Extend
Setup and
Enablement
Discovery
Assessment
Quarterly
Upgrade
Activate new
scope / add
countries
SAP S/4HANA
Cloud
OCM Delivery & Monitoring
* Provisioned and managed by SAP, limited use license.
System
Landscape
Starter System
Trial System
18PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Activate project content
with task descriptions and step-
by-step procedures
SAP Activate process content
including best practice business
processes with process steps
linked to apps, and test scripts
(automatic / manual)
SAP Activate project and process guidance for SAP S/4HANA Cloud
Essential for all deployments
19PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Implementation Portal for SAP S/4HANA Cloud
Content-driven implementation projects
TeamCompany Business Area
Project
management
Task
management
Process
management
20PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Prepare Phase
Starter-System Provisioning and Key User Enablement
1 Review System
Provisioning Process
2 Receive Starter-System
and Reset Password
3 Create Users in the Starter-
System
4 Self-Activation of Key Users
in the IAS System
Starter-System Provisioning
Receive the new cloud system and create the initial users
Key User Enablement
The customer learns different elements of the SAP System and
SAP Activate methodology using self-paced enablement materials
• SAP Methodologies Jam
Community
• Review Quarterly Release Notes
• SAP Best Practices Explorer
• SAP Implementation Room &
Learning Map
• SAP My Learning App
• SAP Learning Hub
21PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Prepare Phase
Project Setup & Business Driven Configuration
Project Plans, Schedule, and Budget
Plan activities during the early stages of the project
1. Create the Project Schedule and Budget
2. Align Project Schedules
Project Kick-Off and On-Boarding
Kick-off the project and ensure that all needed information is
shared with the project team resources
1. Onboard the Project Team
2. Conduct Kick-Off Workshop
Business Driven Configuration
Makes the fit-to-standard process prescriptive and guided by
the process with business questions to drive business
decisions and respective configuration in SAP S/4HANA Cloud
Consultant sets scope based on
project initial scope.
Key users provide written feedback
to business questions and returns
completed questionnaire(s) to the
Implementation Partner.
The customer verifies access to the
Starter-System and all tools used
during the fit-to-standard process.
Implementation Roadmap: Business Driven
Configuration Assessment
Prepare for
Fit-to-Standard
22PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Solution Realization
Fit-to-Standard Workshops
Execute Workshop – Identify Backlog Items and Requirements
Prepare Explore
Fit-to-Standard
Workshop
Preparation
Discovery
Assessment
Business Driven
Configuration
Assessment
Realize
Implement Backlog
Sprints and
Confirmation with
Business and IT
1-2
wks
1-2
wks
Customer Self-Enablement
Discover
Customer Execution of Standard Scenarios
Scoping Process Optimization Process Solution Configuration Process
Release
Planning
Prepare
Customer Self-Enablement
Planning and Design
Workshops
Inputs, Outputs, and Accelerators
Accelerator(s):
• SAP S/4HANA Cloud Tutorials
Document Workshop Findings
Fit-to-Standard
System
Preparation
Solution Definition
Project
Lead
Business Process
Expert(s)
Configuration
Expert(s)
Technical
Expert(s)
Service
Center
Key Roles:
23PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
RunDeployRealizeExploreDiscover Prepare
Continuous Innovation
Deploy SAP S/4HANA Cloud with SAP Activate
Journey Overview and Key Milestones
Journey
and Key
Milestones
Qualification / Brand Guardian
Discovery Assessment
Onboard Project
Team
Finalized scope and backlog
with delta requirements
Go-Live Readiness
Assessment
Buy
Go-Live
Innovate,
Operate, Support
Onboard Users
and Deploy
Scope and
Configure
Migrate, Integrate,
Test
Fit-to-
Standard
Analysis
Extend
Setup and
Enablement
Discovery
Assessment
Quarterly
Upgrade
Activate new
scope / add
countries
SAP S/4HANA
Cloud
OCM Delivery & Monitoring
* Provisioned and managed by SAP, limited use license.
System
Landscape
Starter System
Trial System
24PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Best Practices for the Fit-to-Standard Analysis
SCOPE
ITEMS
SOLUTION
Example Accelerators
• Scope-item fact sheets - scope description of each
scope item
• Process diagrams - graphical BPML process
diagram with roles
• Test scripts - step by step process documentation
with data
Example Accelerators
• Customer presentation - overview presentation
• Content Library - web page with links to all the SAP
Best Practices content
• Prerequisite matrix - relationship between Scope
Items and Building Blocks
• Delivery supplement - key implementation information
• Master Data Overview - describes master data used in
the Edition
Cloud
Scope Item
Test Scripts Process diagram
Demonstration
25PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ

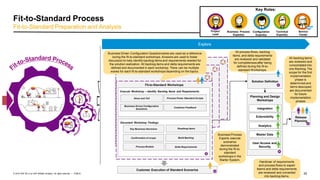

Fit-to-Standard Process
Fit-to-Standard Preparation and Analysis
Explore
Project
Lead
Business Process
Expert(s)
Configuration
Expert(s)
Technical
Expert(s)
Service
Center
Key Roles:
Solution Definition
Fit-to-Standard Workshops
Customer Execution of Standard Scenarios
Release
Planning
Planning and Design
Workshops
Integration
Extensibility
Execute Workshop – Identify Backlog Items and Requirements
Process Flows /Standard ScriptsShow and Tell
Business Driven Configuration
Questions
Customer Feedback
Document Workshop Findings
Build Backlog
Key Business Decisions Roadmap items
Confirmation of scope
Process Models Delta Requirements
Analytics
Master Data
User Access and
Security
Business Driven Configuration Questionnaires are used as a reference
during the fit-to-standard workshops. Answers are used to foster
discussion to help identify backlog items and requirements needed for
the solution realization. All backlog items and delta requirements are
defined and documented in each workshop. There can be multiple
waves for each fit-to-standard workshops depending on the topics.
All process flows, backlog
items, and delta requirements
are reviewed and validated
for completenessafter being
defined during the fit-to-
standard Workshops.
All backlog items
are reviewed and
consolidated into
one Backlog. The
scope for the first
implementation
phase is
determined and
items descoped
are documented
for future
implementation
phases
Handover of requirements
and process flows to expert
teams and delta requirements
are reviewed and converted
into backlog items.
Business Process
Experts execute
scenarios
demonstrated
during the fit-to-
standard
workshops in the
Starter System.
26PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Overview: Business Driven Configuration Process
Fit-to-Standard and System Configuration Supported by Business Driven Configuration
Validate the
Scope Item
Process Flow
2b. Consultant prepares for fit-to-standard
workshop
• Review the Business Driven Configuration
questions and decide when to use them in
the workshop (Excel)
• Review the functionality in the system for
Scope Item J55 - Profitability and Cost
Analysis
• Review Test Script and Process Flow for
relevant scope items in BPX (for purpose of
this demo – J55)
• Adjust the demo data and confirm that you
have all demo users ready, conduct dry run
walk through
1. Consultants access guidance for
preparing the fit-to-standard
workshop
• Open SAP Roadmap Viewer + log on
• Navigate to Solution Specific → SAP
Activate for SAP S/4HANA Cloud
• Drill down to the Prepare phase,
Business Driven Configuration
Assessment deliverable
• Review the task description and
access accelerators to schedule fit-to-
standard workshop
• Ask customer to review and answer
Business Driven Configuration
Questions
2a. Customer prepares for fit-to-
standard workshop
• Review the Business Driven
Configuration Questions and
prepare answers prior to the
workshop (Excel)
3. Run fit-to-standard workshop and capture configuration values
• Consultant runs the fit-to-standard workshop per guidance provided
in the methodology
• Capture results in the backlog
• Plan agile configuration cycles for Realize phase
• Configure system using Guided Configuration capabilities in the Q-
System
Select Business
Questions for Workshop
WorkshopPlanning
Template
Confirm you can do dry run in
Starter System
Configuration SSCUI
(example)
SSCUI - Cost Centers: Automatic Account
Assignment
4. Configure the system
• The configuration requirements are captured in backlog
and project team uses SSCUI or Expert Configuration to
implement them in Realize phase.
27PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Fit-to-Standard Execution
Overall WorkshopApproach
1
2
4
5
Review Best
Practices
process flow
Demonstrate
Scope Item
and
Concepts
Discuss how the processes
fit with the customer’s
requirements
Identify
required
configuration
Enable customer
execution of standard
scenarios
Configuration expert enables
the business process expert to
execute the process on their
own in the Starter system.
Team leverages the Business Driven
Configuration Questionnaire to
arrive at critical configuration
decisions. All configuration values
required and any needed in-app
extensions are determined and
documented in the backlog. The
customer is responsible for providing
value lists. i.e. product group definition.
Configuration expert
demonstrates the scope item
using the starter system and
delivered master data and
highlights the areas that require
configuration decisions. The
process flow is used as a point
of reference when transitioning
in the system.
Configuration expert explains
the scope item using the SAP
Best Practices process flow
and responses from the
Business Driven
Configuration Questionnaire.
Team fosters discussion to better understand
the customer business requirements,
referencing the Business Driven
Configuration Questionnaire, and to provide
understanding of how the solution meets these
requirements.
Identify Delta
Requirements
Team identifies and catalogs the delta
requirements in the backlog for further
analysis and closure. Delta requirements
are business requirements that cannot be
satisfied with the standard scenarios.
6
3
* Repeat process for each scenario
**Iterate throughall process variations
Business Process
Expert(s)
Configuration
Expert(s)
Backlog
Delta
Requirements
28PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
RunDeployRealizeExploreDiscover Prepare
Continuous Innovation
Deploy SAP S/4HANA Cloud with SAP Activate
Journey Overview and Key Milestones
Journey
and Key
Milestones
Qualification / Brand Guardian
Discovery Assessment
Onboard Project
Team
Finalized scope and backlog
with delta requirements
Go-Live Readiness
Assessment
Buy
Go-Live
Innovate,
Operate, Support
Onboard Users
and Deploy
Scope and
Configure
Migrate, Integrate,
Test
Fit-to-
Standard
Analysis
Extend
Setup and
Enablement
Discovery
Assessment
Quarterly
Upgrade
Activate new
scope / add
countries
SAP S/4HANA
Cloud
OCM Delivery & Monitoring
Quality System
Production System
System
Landscape
* Provisioned and managed by SAP, limited use license.
Initial Transport Ongoing Transports
Starter System
Trial System
29PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
View Solution Scope
Get a scope summary:
• Evaluate which business
processes (scope items
of the pre-configuration
best practices) and
which country versions
are active in your
solution
• Display scope items of
all activated solution
packages or of certain
solution packages
• Get detailed
understanding of the
functional scope by
scope item
30PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Activate Configuration Approach for SAP S/4HANA Cloud
Self Service Configuration User Interface (SSCUI)
Configure your SAP S/4HANA Solution
using in-app guided configuration UIs
• Navigate to the Manage Your Solution app
in your SAP S/4HANA system
• Choose Configure your Solution
• Follow the predefined configuration sequence
and choose Start on the relevant
configuration
31PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Activate Configuration Approach for SAP S/4HANA Cloud
Expert Configuration
 Additional functionality and scenarios are possible as defined in the Expert Configuration and SSCUI
Reference Template.
 No Self-service Configuration User interfaces available.
 Initiated by an Incident/Service Request and performed by the services center.
 Expert Configuration is defined during the Explore phase and requested in Realize.
Self-Service
Configuration
Expert
Configuration
SAP Service
Center
Customer
32PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Solution Configuration
Sprint Based Agile Configuration Approach
▪ Short configuration cycles including testing, reviewing and transporting
▪ Configuration is based on the consolidated backlog
▪ Complete testing of each sprint outcome
▪ Sprint reviews of what has been configured in the system to verify that business needs are satisfied
▪ Weekly transports to Production via a change project
Key Message
Backlog
Weekly Transports to P
Configure
TestReview
Configure
TestReview
Weekly Sprints
Configuration
Expert(s)
Service
Center
Integration
Implementation Expert(s)
33PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
RunDeployRealizeExploreDiscover Prepare
Continuous Innovation
Deploy SAP S/4HANA Cloud with SAP Activate
Journey Overview and Key Milestones
Journey
and Key
Milestones
Qualification / Brand Guardian
Discovery Assessment
Onboard Project
Team
Finalized scope and backlog
with delta requirements
Go-Live Readiness
Assessment
Buy
Go-Live
Innovate,
Operate, Support
Onboard Users
and Deploy
Scope and
Configure
Migrate, Integrate,
Test
Fit-to-
Standard
Analysis
Extend
Setup and
Enablement
Discovery
Assessment
Quarterly
Upgrade
Activate new
scope / add
countries
SAP S/4HANA
Cloud
OCM Delivery & Monitoring
Quality System
Production System
System
Landscape
* Provisioned and managed by SAP, limited use license.
Initial Transport Ongoing Transports
Starter System
Trial System
34PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Landscape and Upgrades
Landscape Overview
Starter
System
SAP FINANCIAL
SERVICES NETWORK
*This is the current state of planning and may
be changed by SAP at any time without notice
OTHER
APPS
Quality
System
Productive
System
SAP Cloud
Platform Identity
Authentication
Service (IAS)
Side by Side
Extensibility
Starter System
Includes configuration and master data for
your selected cloud solution for targeted
enablement of the project team on SAP
standard processes and to be the host
environment of the fit-to-standard
workshops.
Quality System
The Quality system is your configurable
system during implementation. After your
S/4HANA system is live, the Quality system
will act as a test environment for further
configurations, and a quality assurance
check during the quarterly updates during
which the Q system will be updated two
weeks ahead of the Productive system to
give ample time for testing.
Productive System
Run your business on SAP S/4HANA
Cloud. The Productive system is the
system in which your business will
transact, plan, and run. This system
will automatically update to the latest
product version once a quarter (after
a two week testing period in the Q
system).
SAP Cloud Platform Identity
Authentication Service (IAS)
SAP Cloud Platform Identity
Authentication provides secure
access to web applications.
Test Tenant (Optional)
Subscription based tenant for testing
innovation without impacting the Q or
P systems. No transport path.
35PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ

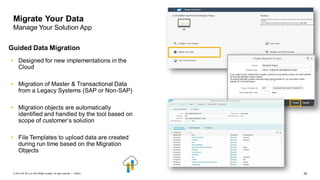

Migrate Your Data
Manage Your Solution App
Guided Data Migration
• Designed for new implementations in the
Cloud
• Migration of Master & Transactional Data
from a Legacy Systems (SAP or Non-SAP)
• Migration objects are automatically
identified and handled by the tool based on
scope of customer’s solution
• File Templates to upload data are created
during run time based on the Migration
Objects
36PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ

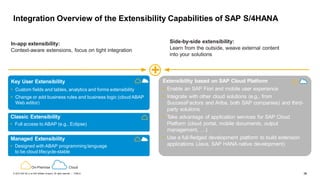

Integration Overview of the Extensibility Capabilities of SAP S/4HANA
Extensibility based on SAP Cloud Platform
 Enable an SAP Fiori and mobile user experience
 Integrate with other cloud solutions (e.g., from
SuccessFactors and Ariba, both SAP companies) and third-
party solutions
 Take advantage of application services for SAP Cloud
Platform (cloud portal, mobile documents, output
management, …)
 Use a full-fledged development platform to build extension
applications (Java, SAP HANA native development)
Key User Extensibility
 Custom fields and tables, analytics and forms extensibility
 Change or add business rules and business logic (cloud ABAP
Web editor)
Managed Extensibility
 Designed with ABAP programming language
to be cloud lifecycle-stable
On-Premise
In-app extensibility:
Context-aware extensions, focus on tight integration
Side-by-side extensibility:
Learn from the outside, weave external content
into your solutions
+
Cloud
Classic Extensibility
 Full access to ABAP (e.g., Eclipse)
37PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Starter-System Q-System P-System
Project Started Fit-to-Standard Analysis Sprint 1 Solution Tested Start of Production
User
Acceptance
Test
Project Testing
Strategy
Test
Plan
Unit
Testing
String
Testing
Unit
Testing
Integration Test
Configure Testing Tools
Data Migration Test 1 Data Migration Test 2-n
Test Case Development
Test Team Mobilization and
Training Roles / Authorizations Testing
Project System
Environment
Project Milestone
Testing Deliverables
Sprint 2-n
SAPACTIVATE Methodology
Testing Overview for SAP S/4HANA Cloud
Explore Realize DeployPrepare
38PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Test Automation Tool for SAP S/4HANA Cloud
Business Benefits
The Test Automation Tool is integral part of SAP S/4HANA Cloud. With preconfigured test scripts you can automate your
business process tests. In addition, you can change existing or create new test cases via a recording functionality. In addition,
regression testing is supported by SAP delivered test automats on app level.
Business Benefits:
Acceleration: Accelerate business process and
regression tests via test automation
Accurate: Reach a sound test result even
during short test cycles like upgrade tests
Fast Outcome Ease the implementation by
providing a quick-check possibility with
preconfigured test scripts
Configurable: Facilitate test script creation with
a recording functionality
Documentation: Documents all automated test
activities with screenshots
Analysis: Results dashboard with drill down
functionality
39PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
RunDeployRealizeExploreDiscover Prepare
Continuous Innovation
Deploy SAP S/4HANA Cloud with SAP Activate
Journey Overview and Key Milestones
Journey
and Key
Milestones
Qualification / Brand Guardian
Discovery Assessment
Onboard Project
Team
Finalized scope and backlog
with delta requirements
Go-Live Readiness
Assessment
Buy
Go-Live
Innovate,
Operate, Support
Onboard Users
and Deploy
Scope and
Configure
Migrate, Integrate,
Test
Fit-to-
Standard
Analysis
Extend
Setup and
Enablement
Discovery
Assessment
Quarterly
Upgrade
Activate new
scope / add
countries
SAP S/4HANA
Cloud
OCM Delivery & Monitoring
Quality System
Production System
System
Landscape
* Provisioned and managed by SAP, limited use license.
Initial Transport Ongoing Transports
Starter System
Trial System
40PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Self Enablement Activities
Access the Resources to Prepare You for Your Project and Enable You for Your SAP S/4HANA Cloud Journey
My Learning Hub
• Provides a full digital foundation for SAP professional
education. It is a cloud-based solution with anytime,
anywhere access, which helps professionals, users, or
academic students develop and update skills on SAP
solutions as needed, including preparation for SAP
certification exams.
Learning Hub
Implementation Roadmap: Customer Team Self Enablement
Start self-enablement
for all project team
members now!
41PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Self Enablement Activities
Learning Center – Review In Solution Trainer Demonstrations
1 – Open Help
2 – Select Learning
3 – Select Role
4 – View Learning
1
2
3
4
Implementation Roadmap - Review Getting
Started Tutorials in the My Learning App
42PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
RunDeployRealizeExploreDiscover Prepare
Continuous Innovation
Deploy SAP S/4HANA Cloud with SAP Activate
Journey Overview and Key Milestones
Journey
and Key
Milestones
Qualification / Brand Guardian
Discovery Assessment
Onboard Project
Team
Finalized scope and backlog
with delta requirements
Go-Live Readiness
Assessment
Buy
Go-Live
Innovate,
Operate, Support
Onboard Users
and Deploy
Scope and
Configure
Migrate, Integrate,
Test
Fit-to-
Standard
Analysis
Extend
Setup and
Enablement
Discovery
Assessment
Quarterly
Upgrade
Activate new
scope / add
countries
SAP S/4HANA
Cloud
OCM Delivery & Monitoring
Quality System
Production System
System
Landscape
* Provisioned and managed by SAP, limited use license.
Initial Transport Ongoing Transports
Starter System
Trial System
43PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Provides detailed guidance for your successful
use of your SAP S/4HANA Cloud solution
• Continuous learning and enablement + add
new users
• Ongoing system operations, including
interfaces (for example Vertex)
• Quarterly release upgrades and regression test
• Continuous improvement, activation of new
scope
• Leveraging the SAP Cloud Trust Center
• Using SAP Support services as needed
SAP Activate Run Phase
Overview
44PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Quarterly Release Upgrade
Upgrades and Content Corrections
• Content corrections are generally scheduled on a two week period and are deployed to all customers over the weekend
during standard downtimes. Note that exceptions exist that may delay the schedule.
• Upgrades are scheduled on a quarterly basis.
• All customers are on the same release and hotfix package.
• Service marketplace notes are not individually applied. They must be part of a hotfix.
• SLA (Service Level Agreement) for cloud services can be found here.
• SAP notifies via email, release upgrade schedule to each customer, at least 6 weeks in advance.
• Details on the quarterly upgrade schedule and patching schedule can be found here.
• See the Roadmap Viewer for additional Upgrade Guidance. Quarterly Release Cycle.
• See the SAP Trust Center Cloud Service Status here.
Upgrades and Content Corrections
Starter
System
Quality
System
Productive
System
SAP S/4HANA Cloud
Customer Landscape
45PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Landscape and Upgrades
Quarterly Upgrade Process
Sa Su Mo Tu We Th Fr Sa Su Mo Tu We Th Fr Sa Su Mo Tu We Th Fr Sa Su
Q-SystemP-System
Q-SystemUpgrade*
• Pre-Processing
by Service
Center
• Regression testing of business processes
• For customers not live on the P-System, configuration can
continue once the Q-System has been successfully regression
tested
P-System
Upgrade*
The project schedule should include
upgrade periods and post upgrade
regression testing.
• Transport
Sprint Change
Projects
• Export
Software
Collection
(ATO queue)
*Q and P systems are not available during the upgrade for that system
• Import
Software
Collection (ATO
queue clear)
• No Transports from Q to P
• Production Go Live should not be scheduled in this period since no
transports are possible
46PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Landscape and Upgrades

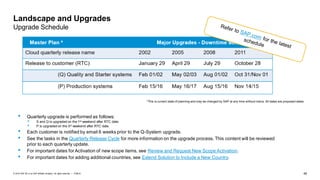

Upgrade Schedule
*This is current state of planning and may be changed by SAP at any time without notice. All dates are proposed dates.
• Quarterly upgrade is performed as follows:
• S and Q is upgraded on the 1st weekend after RTC date.
• P is upgraded on the 3rd weekend after RTC date.
• Each customer is notified by email 6 weeks prior to the Q-System upgrade.
• See the tasks in the Quarterly Release Cycle for more information on the upgrade process. This content will be reviewed
prior to each quarterly update.
• For important dates for Activation of new scope items, see Review and Request New Scope Activation.
• For important dates for adding additional countries, see Extend Solution to Include a New Country.
47PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Agenda
Introduction to Cloud
Trial
Setup and Enablement
Fit-to-Standard
Scope and Configure
Migration, Integrate, Extend and Test
Deploy
Operate, Monitor, and Support
SAP Activate Apps and Enablement
The Road to SAP S/4HANA Cloud with SAP Activate
48PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Enablers for Your Digital Transformation
SAP Activate Tools and Community
SAP Activate Jam Community
• Engage SAP Activate experts
• Ask questions and collaborate
• Stay up to date
• Request access at
http://bit.ly/SAPActivate
SAP Roadmap Viewer
• Browse implementation guidance for
your digital transformation
• Access SAP Activate methodology
assets and accelerators
• https://go.support.sap.com/roadmapv
iewer/#
SAP Best Practices Explorer
• Access SAP Best Practices content
• Power your project with ready-to-run
processes
• https://rapid.sap.com/bp/
49PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Activate Methodology Training Curriculum
Available to Customers, Partners and SAP Consultants
Courses
• ACT10e – Introduction to SAP Activate Methodology*
• ACT200 – Agile Project Delivery (2 day classroom course)
• ACT1CL – SAP Activate Methodology: Introduction (Cloud)
• ACT2CL – SAP Activate Methodology: Cloud Implementation
Certification
• C_ACTIVATE05 – SAP Certified Associate -
SAP Activate Project Manager
* Also offered as classroom training ACT100
50PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
“SAP has an Activate process which really helps takes those
best practices and drives standardization, particularly for
cloud.”
“It’s really important that it’s a journey you want to go on from a
change management perspective and that Activate Methodology
really helped us sit down and look at our processes and then
map to best practices and common business practices.”
Kris Cowles, VP, Global Application IT, Topcon Corp.
SAPPHIRE NOW 2018 Orlando, June 2018
Carrier discusses how SAP Activate guided them on their
implementation journey – focusing on the fit-to-standard
approach.
“For us fit-to-standard meant that we could make a transformation,
make a migration, convert the organization on to a standard that is
continuously moving... we looked at it as a business transformation,
the ability to say ‘what are the best practices,’adopting those from
our partners – fitting our organization into those approaches and
then being able to move forward in a rapid pace.”
Scott Moore, Managing Director, Carrier Corp.
SAPPHIRE NOW 2018 Orlando, June 2018
Proof Points: Customer Value and Key Differentiators with SAP Activate
51PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
SAP Partners are Adopting SAP Activate in Their delivery
“NTT DATA grew its SAP business during the past
years massively to above 10,000 SAP people globally.
Hereby, NTT DATA’s One Method plays the key role to
providing highest quality in SAP implementation to
employees and clients. The reason for success is
owing to the great structure and content of SAP
Activate, which NTT DATA continuously adopts to
provide the best SAP standards to its people. SAP
Activate has everything NTT DATA needs, because it
covers the best expertise in S/4HANA and Cloud, and
is being increasingly used for the new
implementations, conversions, and transformations of
our clients.”
“We are lock step with SAP on their
Activate journey which is designed to
achieve value faster through the
application of agile techniques.”
“The release of SAP Activate has been perfectly
timed for a market demanding the use of Rapid
Deployment Solutions and deployed using Agile
techniques. IBM has wholeheartedly embraced
Activate and Agile within its own new IBM Ascend
methodology and Impact Industry Solution. Our
Clients have welcomed this new approach that
generates faster speed to value under a lower risk
delivery approach.”
“Cognizant has been using the SAP Activate innovation
adoption framework to accelerate many digital
transformation programs for clients. The combination of
Activate and Cognizant’s own hybrid agile methodology has
helped us to take a programmatic approach that clients have
welcomed because of the increased transparency, improved
quality and agile infused adaptability it provides.”
“SAP Activate formalizes the agile, lean, and
DevOps approach Capgemini embraces to help
clients achieve market leadership in the face of
unrelenting change. That’s why we fully commit
to the SAP Activate Framework — because we
measure our value to clients by how fast, how
often, and how well we help them innovate.”
“T-Systems has been achieving best results for its
customers by blending SAP Methodologies with
its own. The SAP Activate innovation adoption
framework has introduced a kick start method for
total digital transformation. T-Systems offers its
customers the best of both worlds for accelerated
SAP S/4HANA implementations from end-to-end
through the use of standardized transformation
packages, agile methods and best practice. The
tools and templates from the SAP Activate
framework combined with T-Systems own SAP
S/4HANA Transformation methodology reduces
project risks and delivers faster customer
success.”
52PUBLIC© 2019 SAP SE or an SAP affiliate company. All rights reserved. ǀ
Community benefits:
▪ Learn from our experts on various topics, gaining key insights, and stay up-to-date on the latest releases
▪ Webinars & events outlining the key topics which help organizations during project phases
▪ Open hours to engage live with our methodology experts
▪ Interactive collaboration with users regarding content, questions, and updates
▪ FREE access to the latest content to help organizations with projects
Join our community today: http://bit.ly/SAPActivate
Current members, access our community by clicking here
SAP Activate Methodology Jam Group
Join the Exclusive Community with the Latest Content on SAP Activate Methodology!
Contact information:
Jan Musil
Chief Product Owner
SAP Activate Methodology
SAPActivateMethodology@sap.com
Thank you.

S4 h 188 sap s4hana cloud implementation with sap activate

  • 1.
    PUBLIC SAP Activate 2002 February11, 2020 Deploying SAP S/4HANA Cloud with SAP Activate
  • 2.
    2PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Agenda Introduction to Cloud Trial Setup and Enablement Fit-to-Standard Scope and Configure Migration, Integrate, Extend and Test Deploy Operate, Monitor, and Support SAP Activate Apps and Enablement The Road to SAP S/4HANA Cloud with SAP Activate
  • 3.
    3PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP S/4HANA Deployment Options SAP S/4HANA Designed for enterprises across industries that need a deep and broad level of functionality combined with a high degree of flexibility in customization SAP S/4HANA CLOUD Designed for enterprises that need a standardized cloud offering primarily covering the core business scenarios of an enterprise or specific business scenarios of lines of business in industries - combined with a fast innovation cycle (quarterly) CONTROL & FLEXIBILITY EFFICIENCY HYBRID SCENARIOS Combining on-premise and cloud solutions for unprecedented IT flexibility and accelerated business innovation.
  • 4.
    4PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Customers have questions about deployment of SAP S/4HANA Cloud SAP Activate guides them along their journey How do we integrate our ERP system into our solution landscape? Who is accountable for what deliverables? Who will do what? How will standard business content and processes support my business needs? How do I enable my team to implement cloud solution “the right way”? How do I get started? What resources do I need to be successful? How will we setup printers in our cloud environment? How will we extend the solution where it doesn’t cover our needs out of the box? How do we identify all our requirements and make sure they are implemented well in the software? How can I request Q-system? What information do I need to provide? What steps will we take to ensure quality of the solution for our business users? What do we need to do in each quarterly upgrade? SAP Activate How, what, why ….
  • 5.
    5PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Launch quickly and efficiently, standardized for integration Self-service to expand capabilities when, where, and how you choose Business Processes Delivered Ready to Run Clear Methodology for Adoption and Extensibility Apps for Adoption and Extensibility Business-Driven Innovation with SAP Activate Self-service configuration through a clear deployment methodology of solution-specific practices, in a standardized environment Speed of Innovation Greater Productivity Business ImpactGrowth & Scalability Innovation as a Service is how your business deploys new capabilities, when and how you choose, to build a sustained competitive advantage SAP Activate
  • 6.
    6PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Best Practices SAP Cloud ALM Methodology Agile implementation methodology with role-based detailed implementation tasks, available as content in the implementation portal and in the Roadmap Viewer. RunDeployRealizeExploreDiscover Prepare Innovate, Operate, Support Onboard and Deploy Scope and Configure Migrate, Integrate, Test Fit-to- Standard Analysis Extend Setup and Enablement Discovery Assessment Continuous innovation Ready-to-use business processes, available in all SAP S/4HANA Cloud tenants. Start the scoping and the configuration with standard processes. Guided implementation with flexible task and content management leveraging best- practices content and methodology content combined to accelerate the implementation. Deployment experience with SAP Activate
  • 7.
    7PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ EFFECTIVE GOVERNANCE STANDARDIZED FAST INNOVATIONS DYNAMIC EXTENSIBILITY GUIDED CONFIGURATION NATIVE INTEGRATION Focused scope solutions Quarterly innovation cycle Extensions via SAP Cloud Platform Fully managed by SAP SuccessFactors Employee Central, Ariba Network, SAP hybris Marketing, Fieldglass, SAP Jam Ready-to-run SAP Best Practices business processes - Enterprise Management - Professional Services - Finance - Manufacturing SUBSCRIPTION CONTRACT Pay as you go Cloud SAP S/4HANA Cloud Drive the Digital Transformation with the Simplicity of the Cloud
  • 8.
    8PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Activate Implementation Methodology How Do SAP Cloud Implementation Projects Differ? Standardized Solution Focused scope solutions that allow tailoring to fit the customer’s business and reduce complexity Roles Customer owns many more tasks of a public cloud implementation such as data migration, testing and change management Handover to Support Cloud customers are handed over to SAP Cloud Support for long term system management Project Timeline Public cloud project is initiated immediately following contract signature with go live in 2 to 25 weeks System Landscape Public cloud solutions typically use only one test system and a production system Innovation Upgrades to public cloud solutions are automatically applied by SAP every three months
  • 9.
    9PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ RunDeployRealizeExploreDiscover Prepare Continuous Innovation Deploy SAP S/4HANA Cloud with SAP Activate Journey Overview and Key Milestones Journey and Key Milestones Qualification / Brand Guardian Discovery Assessment Onboard Project Team Finalized scope and backlog with delta requirements Go-Live Readiness Assessment Buy Go-Live Innovate, Operate, Support Onboard Users and Deploy Scope and Configure Migrate, Integrate, Test Fit-to- Standard Analysis Extend Setup and Enablement Discovery Assessment Quarterly Upgrade Activate new scope / add countries SAP S/4HANA Cloud OCM Delivery & Monitoring Quality System Production System System Landscape * Provisioned and managed by SAP, limited use license. Initial Transport Ongoing Transports Starter System Trial System
  • 10.
    10PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Agenda Introduction to Cloud Trial Setup and Enablement Fit-to-Standard Scope and Configure Migration, Integrate, Extend and Test Deploy Operate, Monitor, and Support SAP Activate Apps and Enablement The Road to SAP S/4HANA Cloud with SAP Activate
  • 11.
    11PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ RunDeployRealizeExploreDiscover Prepare Continuous Innovation Deploy SAP S/4HANA Cloud with SAP Activate Journey Overview and Key Milestones Journey and Key Milestones Qualification / Brand Guardian Discovery Assessment Onboard Project Team Finalized scope and backlog with delta requirements Go-Live Readiness Assessment Buy Go-Live Innovate, Operate, Support Onboard Users and Deploy Scope and Configure Migrate, Integrate, Test Fit-to- Standard Analysis Extend Setup and Enablement Discovery Assessment Quarterly Upgrade Activate new scope / add countries SAP S/4HANA Cloud OCM Delivery & Monitoring System Landscape * Provisioned and managed by SAP, limited use license. Trial System
  • 12.
    12PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Discover Sample Processes SAP S/4HANA Cloud Trial SAP Best Practices Explorer RunDeployRealizeExploreDiscover Prepare SAP S/4HANA Cloud Deployment Experience using SAP Activate Deployment Tools Test Processes based on automated scripts Configure your Solution SAP S/4HANA Migration Cockpit Test Automation Tool S/4HANA Cloud SAP Roadmap Viewer Discovery Access Operate, Monitor, Support Fit-to-Standard Analysis Scope and Configure Migrate, Integrate, Extend, Test Continuous Innovation Regression Test based on automated scripts Operate, Monitor, Support Onboard Users and Deploy Implement Customer Requirements via Guided Configuration Upload Data with predefined Templates Leverage end-to-end deployment roadmap Evaluate available SAP Best Practices
  • 13.
    13PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP S/4HANA Cloud (14 days) SAP S/4HANA Trial System Access Trial Edition: http://www.sap.com/s4hana-trial Web SAP S/4HANA Cloud Instantly access fully activated business processes with sample data and organization structure. Follow guided tours to learn about SAP S/4HANA Cloud. Browse, view and download SAP Best Practices content. View SAP Activate methodology roadmap online. SAP Best Practices Explorer Discover SAP Best Practices process content SAP Roadmap Viewer Discover methodology in the form of an S/4HANA roadmap SAP S/4HANA Discover SAP Best Practices processes in the starter system Test Drive SAP Trial System & Explore SAP Activate Discover Processes and Functions prior to Implementation Experience Trial
  • 14.
    14PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Analytics Cloud SAP Business One Cloud SAP Hybris Revenue Cloud SAP Asset Intelligence Network SAP Predictive Maintenance and Service SAP Best Practices for Integration of S/4HANA Cloud Dedicated capabilities reflect market buying behavior via LOB/Industry Recommendations of specific functionality delivered in the cloud for ease of adoption Pre-configured scenarios to drive Economies of Scale and standardization Intelligent core SAP Cloud for Customer
  • 15.
    16PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Digital Discovery Assessment Assessment of Solution Scope Document and capture project scope, through the SAP Digital Discovery, to generate a scoping report. The report will be used as a project scoping reference during the phases of the Implementation. SAP Digital Discovery Assessment: • https://sap.com/s4hanacloud-discovery Benefits: • Provides clear visibility and insight into the current SAP Best Practices scope items • Centralize documentation and validation of integration and extensibility items of SAP and non-SAP solutions within the customer’s landscape • Help in documenting additional requirements identified in the customer’s landscape • Generate a detailed report, that is used to validate integrations and outstanding questions that was captured during the SAP Digital Discovery Process Access the Digital Discovery Assessment
  • 16.
    17PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ RunDeployRealizeExploreDiscover Prepare Continuous Innovation Deploy SAP S/4HANA Cloud with SAP Activate Journey Overview and Key Milestones Journey and Key Milestones Qualification / Brand Guardian Discovery Assessment Onboard Project Team Finalized scope and backlog with delta requirements Go-Live Readiness Assessment Buy Go-Live Innovate, Operate, Support Onboard Users and Deploy Scope and Configure Migrate, Integrate, Test Fit-to- Standard Analysis Extend Setup and Enablement Discovery Assessment Quarterly Upgrade Activate new scope / add countries SAP S/4HANA Cloud OCM Delivery & Monitoring * Provisioned and managed by SAP, limited use license. System Landscape Starter System Trial System
  • 17.
    18PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Activate project content with task descriptions and step- by-step procedures SAP Activate process content including best practice business processes with process steps linked to apps, and test scripts (automatic / manual) SAP Activate project and process guidance for SAP S/4HANA Cloud Essential for all deployments
  • 18.
    19PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Implementation Portal for SAP S/4HANA Cloud Content-driven implementation projects TeamCompany Business Area Project management Task management Process management
  • 19.
    20PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Prepare Phase Starter-System Provisioning and Key User Enablement 1 Review System Provisioning Process 2 Receive Starter-System and Reset Password 3 Create Users in the Starter- System 4 Self-Activation of Key Users in the IAS System Starter-System Provisioning Receive the new cloud system and create the initial users Key User Enablement The customer learns different elements of the SAP System and SAP Activate methodology using self-paced enablement materials • SAP Methodologies Jam Community • Review Quarterly Release Notes • SAP Best Practices Explorer • SAP Implementation Room & Learning Map • SAP My Learning App • SAP Learning Hub
  • 20.
    21PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Prepare Phase Project Setup & Business Driven Configuration Project Plans, Schedule, and Budget Plan activities during the early stages of the project 1. Create the Project Schedule and Budget 2. Align Project Schedules Project Kick-Off and On-Boarding Kick-off the project and ensure that all needed information is shared with the project team resources 1. Onboard the Project Team 2. Conduct Kick-Off Workshop Business Driven Configuration Makes the fit-to-standard process prescriptive and guided by the process with business questions to drive business decisions and respective configuration in SAP S/4HANA Cloud Consultant sets scope based on project initial scope. Key users provide written feedback to business questions and returns completed questionnaire(s) to the Implementation Partner. The customer verifies access to the Starter-System and all tools used during the fit-to-standard process. Implementation Roadmap: Business Driven Configuration Assessment Prepare for Fit-to-Standard
  • 21.
    22PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Solution Realization Fit-to-Standard Workshops Execute Workshop – Identify Backlog Items and Requirements Prepare Explore Fit-to-Standard Workshop Preparation Discovery Assessment Business Driven Configuration Assessment Realize Implement Backlog Sprints and Confirmation with Business and IT 1-2 wks 1-2 wks Customer Self-Enablement Discover Customer Execution of Standard Scenarios Scoping Process Optimization Process Solution Configuration Process Release Planning Prepare Customer Self-Enablement Planning and Design Workshops Inputs, Outputs, and Accelerators Accelerator(s): • SAP S/4HANA Cloud Tutorials Document Workshop Findings Fit-to-Standard System Preparation Solution Definition Project Lead Business Process Expert(s) Configuration Expert(s) Technical Expert(s) Service Center Key Roles:
  • 22.
    23PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ RunDeployRealizeExploreDiscover Prepare Continuous Innovation Deploy SAP S/4HANA Cloud with SAP Activate Journey Overview and Key Milestones Journey and Key Milestones Qualification / Brand Guardian Discovery Assessment Onboard Project Team Finalized scope and backlog with delta requirements Go-Live Readiness Assessment Buy Go-Live Innovate, Operate, Support Onboard Users and Deploy Scope and Configure Migrate, Integrate, Test Fit-to- Standard Analysis Extend Setup and Enablement Discovery Assessment Quarterly Upgrade Activate new scope / add countries SAP S/4HANA Cloud OCM Delivery & Monitoring * Provisioned and managed by SAP, limited use license. System Landscape Starter System Trial System
  • 23.
    24PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Best Practices for the Fit-to-Standard Analysis SCOPE ITEMS SOLUTION Example Accelerators • Scope-item fact sheets - scope description of each scope item • Process diagrams - graphical BPML process diagram with roles • Test scripts - step by step process documentation with data Example Accelerators • Customer presentation - overview presentation • Content Library - web page with links to all the SAP Best Practices content • Prerequisite matrix - relationship between Scope Items and Building Blocks • Delivery supplement - key implementation information • Master Data Overview - describes master data used in the Edition Cloud Scope Item Test Scripts Process diagram Demonstration
  • 24.
    25PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Fit-to-Standard Process Fit-to-Standard Preparation and Analysis Explore Project Lead Business Process Expert(s) Configuration Expert(s) Technical Expert(s) Service Center Key Roles: Solution Definition Fit-to-Standard Workshops Customer Execution of Standard Scenarios Release Planning Planning and Design Workshops Integration Extensibility Execute Workshop – Identify Backlog Items and Requirements Process Flows /Standard ScriptsShow and Tell Business Driven Configuration Questions Customer Feedback Document Workshop Findings Build Backlog Key Business Decisions Roadmap items Confirmation of scope Process Models Delta Requirements Analytics Master Data User Access and Security Business Driven Configuration Questionnaires are used as a reference during the fit-to-standard workshops. Answers are used to foster discussion to help identify backlog items and requirements needed for the solution realization. All backlog items and delta requirements are defined and documented in each workshop. There can be multiple waves for each fit-to-standard workshops depending on the topics. All process flows, backlog items, and delta requirements are reviewed and validated for completenessafter being defined during the fit-to- standard Workshops. All backlog items are reviewed and consolidated into one Backlog. The scope for the first implementation phase is determined and items descoped are documented for future implementation phases Handover of requirements and process flows to expert teams and delta requirements are reviewed and converted into backlog items. Business Process Experts execute scenarios demonstrated during the fit-to- standard workshops in the Starter System.
  • 25.
    26PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Overview: Business Driven Configuration Process Fit-to-Standard and System Configuration Supported by Business Driven Configuration Validate the Scope Item Process Flow 2b. Consultant prepares for fit-to-standard workshop • Review the Business Driven Configuration questions and decide when to use them in the workshop (Excel) • Review the functionality in the system for Scope Item J55 - Profitability and Cost Analysis • Review Test Script and Process Flow for relevant scope items in BPX (for purpose of this demo – J55) • Adjust the demo data and confirm that you have all demo users ready, conduct dry run walk through 1. Consultants access guidance for preparing the fit-to-standard workshop • Open SAP Roadmap Viewer + log on • Navigate to Solution Specific → SAP Activate for SAP S/4HANA Cloud • Drill down to the Prepare phase, Business Driven Configuration Assessment deliverable • Review the task description and access accelerators to schedule fit-to- standard workshop • Ask customer to review and answer Business Driven Configuration Questions 2a. Customer prepares for fit-to- standard workshop • Review the Business Driven Configuration Questions and prepare answers prior to the workshop (Excel) 3. Run fit-to-standard workshop and capture configuration values • Consultant runs the fit-to-standard workshop per guidance provided in the methodology • Capture results in the backlog • Plan agile configuration cycles for Realize phase • Configure system using Guided Configuration capabilities in the Q- System Select Business Questions for Workshop WorkshopPlanning Template Confirm you can do dry run in Starter System Configuration SSCUI (example) SSCUI - Cost Centers: Automatic Account Assignment 4. Configure the system • The configuration requirements are captured in backlog and project team uses SSCUI or Expert Configuration to implement them in Realize phase.
  • 26.
    27PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Fit-to-Standard Execution Overall WorkshopApproach 1 2 4 5 Review Best Practices process flow Demonstrate Scope Item and Concepts Discuss how the processes fit with the customer’s requirements Identify required configuration Enable customer execution of standard scenarios Configuration expert enables the business process expert to execute the process on their own in the Starter system. Team leverages the Business Driven Configuration Questionnaire to arrive at critical configuration decisions. All configuration values required and any needed in-app extensions are determined and documented in the backlog. The customer is responsible for providing value lists. i.e. product group definition. Configuration expert demonstrates the scope item using the starter system and delivered master data and highlights the areas that require configuration decisions. The process flow is used as a point of reference when transitioning in the system. Configuration expert explains the scope item using the SAP Best Practices process flow and responses from the Business Driven Configuration Questionnaire. Team fosters discussion to better understand the customer business requirements, referencing the Business Driven Configuration Questionnaire, and to provide understanding of how the solution meets these requirements. Identify Delta Requirements Team identifies and catalogs the delta requirements in the backlog for further analysis and closure. Delta requirements are business requirements that cannot be satisfied with the standard scenarios. 6 3 * Repeat process for each scenario **Iterate throughall process variations Business Process Expert(s) Configuration Expert(s) Backlog Delta Requirements
  • 27.
    28PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ RunDeployRealizeExploreDiscover Prepare Continuous Innovation Deploy SAP S/4HANA Cloud with SAP Activate Journey Overview and Key Milestones Journey and Key Milestones Qualification / Brand Guardian Discovery Assessment Onboard Project Team Finalized scope and backlog with delta requirements Go-Live Readiness Assessment Buy Go-Live Innovate, Operate, Support Onboard Users and Deploy Scope and Configure Migrate, Integrate, Test Fit-to- Standard Analysis Extend Setup and Enablement Discovery Assessment Quarterly Upgrade Activate new scope / add countries SAP S/4HANA Cloud OCM Delivery & Monitoring Quality System Production System System Landscape * Provisioned and managed by SAP, limited use license. Initial Transport Ongoing Transports Starter System Trial System
  • 28.
    29PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ View Solution Scope Get a scope summary: • Evaluate which business processes (scope items of the pre-configuration best practices) and which country versions are active in your solution • Display scope items of all activated solution packages or of certain solution packages • Get detailed understanding of the functional scope by scope item
  • 29.
    30PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Activate Configuration Approach for SAP S/4HANA Cloud Self Service Configuration User Interface (SSCUI) Configure your SAP S/4HANA Solution using in-app guided configuration UIs • Navigate to the Manage Your Solution app in your SAP S/4HANA system • Choose Configure your Solution • Follow the predefined configuration sequence and choose Start on the relevant configuration
  • 30.
    31PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Activate Configuration Approach for SAP S/4HANA Cloud Expert Configuration  Additional functionality and scenarios are possible as defined in the Expert Configuration and SSCUI Reference Template.  No Self-service Configuration User interfaces available.  Initiated by an Incident/Service Request and performed by the services center.  Expert Configuration is defined during the Explore phase and requested in Realize. Self-Service Configuration Expert Configuration SAP Service Center Customer
  • 31.
    32PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Solution Configuration Sprint Based Agile Configuration Approach ▪ Short configuration cycles including testing, reviewing and transporting ▪ Configuration is based on the consolidated backlog ▪ Complete testing of each sprint outcome ▪ Sprint reviews of what has been configured in the system to verify that business needs are satisfied ▪ Weekly transports to Production via a change project Key Message Backlog Weekly Transports to P Configure TestReview Configure TestReview Weekly Sprints Configuration Expert(s) Service Center Integration Implementation Expert(s)
  • 32.
    33PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ RunDeployRealizeExploreDiscover Prepare Continuous Innovation Deploy SAP S/4HANA Cloud with SAP Activate Journey Overview and Key Milestones Journey and Key Milestones Qualification / Brand Guardian Discovery Assessment Onboard Project Team Finalized scope and backlog with delta requirements Go-Live Readiness Assessment Buy Go-Live Innovate, Operate, Support Onboard Users and Deploy Scope and Configure Migrate, Integrate, Test Fit-to- Standard Analysis Extend Setup and Enablement Discovery Assessment Quarterly Upgrade Activate new scope / add countries SAP S/4HANA Cloud OCM Delivery & Monitoring Quality System Production System System Landscape * Provisioned and managed by SAP, limited use license. Initial Transport Ongoing Transports Starter System Trial System
  • 33.
    34PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Landscape and Upgrades Landscape Overview Starter System SAP FINANCIAL SERVICES NETWORK *This is the current state of planning and may be changed by SAP at any time without notice OTHER APPS Quality System Productive System SAP Cloud Platform Identity Authentication Service (IAS) Side by Side Extensibility Starter System Includes configuration and master data for your selected cloud solution for targeted enablement of the project team on SAP standard processes and to be the host environment of the fit-to-standard workshops. Quality System The Quality system is your configurable system during implementation. After your S/4HANA system is live, the Quality system will act as a test environment for further configurations, and a quality assurance check during the quarterly updates during which the Q system will be updated two weeks ahead of the Productive system to give ample time for testing. Productive System Run your business on SAP S/4HANA Cloud. The Productive system is the system in which your business will transact, plan, and run. This system will automatically update to the latest product version once a quarter (after a two week testing period in the Q system). SAP Cloud Platform Identity Authentication Service (IAS) SAP Cloud Platform Identity Authentication provides secure access to web applications. Test Tenant (Optional) Subscription based tenant for testing innovation without impacting the Q or P systems. No transport path.
  • 34.
    35PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Migrate Your Data Manage Your Solution App Guided Data Migration • Designed for new implementations in the Cloud • Migration of Master & Transactional Data from a Legacy Systems (SAP or Non-SAP) • Migration objects are automatically identified and handled by the tool based on scope of customer’s solution • File Templates to upload data are created during run time based on the Migration Objects
  • 35.
    36PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Integration Overview of the Extensibility Capabilities of SAP S/4HANA Extensibility based on SAP Cloud Platform  Enable an SAP Fiori and mobile user experience  Integrate with other cloud solutions (e.g., from SuccessFactors and Ariba, both SAP companies) and third- party solutions  Take advantage of application services for SAP Cloud Platform (cloud portal, mobile documents, output management, …)  Use a full-fledged development platform to build extension applications (Java, SAP HANA native development) Key User Extensibility  Custom fields and tables, analytics and forms extensibility  Change or add business rules and business logic (cloud ABAP Web editor) Managed Extensibility  Designed with ABAP programming language to be cloud lifecycle-stable On-Premise In-app extensibility: Context-aware extensions, focus on tight integration Side-by-side extensibility: Learn from the outside, weave external content into your solutions + Cloud Classic Extensibility  Full access to ABAP (e.g., Eclipse)
  • 36.
    37PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Starter-System Q-System P-System Project Started Fit-to-Standard Analysis Sprint 1 Solution Tested Start of Production User Acceptance Test Project Testing Strategy Test Plan Unit Testing String Testing Unit Testing Integration Test Configure Testing Tools Data Migration Test 1 Data Migration Test 2-n Test Case Development Test Team Mobilization and Training Roles / Authorizations Testing Project System Environment Project Milestone Testing Deliverables Sprint 2-n SAPACTIVATE Methodology Testing Overview for SAP S/4HANA Cloud Explore Realize DeployPrepare
  • 37.
    38PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Test Automation Tool for SAP S/4HANA Cloud Business Benefits The Test Automation Tool is integral part of SAP S/4HANA Cloud. With preconfigured test scripts you can automate your business process tests. In addition, you can change existing or create new test cases via a recording functionality. In addition, regression testing is supported by SAP delivered test automats on app level. Business Benefits: Acceleration: Accelerate business process and regression tests via test automation Accurate: Reach a sound test result even during short test cycles like upgrade tests Fast Outcome Ease the implementation by providing a quick-check possibility with preconfigured test scripts Configurable: Facilitate test script creation with a recording functionality Documentation: Documents all automated test activities with screenshots Analysis: Results dashboard with drill down functionality
  • 38.
    39PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ RunDeployRealizeExploreDiscover Prepare Continuous Innovation Deploy SAP S/4HANA Cloud with SAP Activate Journey Overview and Key Milestones Journey and Key Milestones Qualification / Brand Guardian Discovery Assessment Onboard Project Team Finalized scope and backlog with delta requirements Go-Live Readiness Assessment Buy Go-Live Innovate, Operate, Support Onboard Users and Deploy Scope and Configure Migrate, Integrate, Test Fit-to- Standard Analysis Extend Setup and Enablement Discovery Assessment Quarterly Upgrade Activate new scope / add countries SAP S/4HANA Cloud OCM Delivery & Monitoring Quality System Production System System Landscape * Provisioned and managed by SAP, limited use license. Initial Transport Ongoing Transports Starter System Trial System
  • 39.
    40PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Self Enablement Activities Access the Resources to Prepare You for Your Project and Enable You for Your SAP S/4HANA Cloud Journey My Learning Hub • Provides a full digital foundation for SAP professional education. It is a cloud-based solution with anytime, anywhere access, which helps professionals, users, or academic students develop and update skills on SAP solutions as needed, including preparation for SAP certification exams. Learning Hub Implementation Roadmap: Customer Team Self Enablement Start self-enablement for all project team members now!
  • 40.
    41PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Self Enablement Activities Learning Center – Review In Solution Trainer Demonstrations 1 – Open Help 2 – Select Learning 3 – Select Role 4 – View Learning 1 2 3 4 Implementation Roadmap - Review Getting Started Tutorials in the My Learning App
  • 41.
    42PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ RunDeployRealizeExploreDiscover Prepare Continuous Innovation Deploy SAP S/4HANA Cloud with SAP Activate Journey Overview and Key Milestones Journey and Key Milestones Qualification / Brand Guardian Discovery Assessment Onboard Project Team Finalized scope and backlog with delta requirements Go-Live Readiness Assessment Buy Go-Live Innovate, Operate, Support Onboard Users and Deploy Scope and Configure Migrate, Integrate, Test Fit-to- Standard Analysis Extend Setup and Enablement Discovery Assessment Quarterly Upgrade Activate new scope / add countries SAP S/4HANA Cloud OCM Delivery & Monitoring Quality System Production System System Landscape * Provisioned and managed by SAP, limited use license. Initial Transport Ongoing Transports Starter System Trial System
  • 42.
    43PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Provides detailed guidance for your successful use of your SAP S/4HANA Cloud solution • Continuous learning and enablement + add new users • Ongoing system operations, including interfaces (for example Vertex) • Quarterly release upgrades and regression test • Continuous improvement, activation of new scope • Leveraging the SAP Cloud Trust Center • Using SAP Support services as needed SAP Activate Run Phase Overview
  • 43.
    44PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Quarterly Release Upgrade Upgrades and Content Corrections • Content corrections are generally scheduled on a two week period and are deployed to all customers over the weekend during standard downtimes. Note that exceptions exist that may delay the schedule. • Upgrades are scheduled on a quarterly basis. • All customers are on the same release and hotfix package. • Service marketplace notes are not individually applied. They must be part of a hotfix. • SLA (Service Level Agreement) for cloud services can be found here. • SAP notifies via email, release upgrade schedule to each customer, at least 6 weeks in advance. • Details on the quarterly upgrade schedule and patching schedule can be found here. • See the Roadmap Viewer for additional Upgrade Guidance. Quarterly Release Cycle. • See the SAP Trust Center Cloud Service Status here. Upgrades and Content Corrections Starter System Quality System Productive System SAP S/4HANA Cloud Customer Landscape
  • 44.
    45PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Landscape and Upgrades Quarterly Upgrade Process Sa Su Mo Tu We Th Fr Sa Su Mo Tu We Th Fr Sa Su Mo Tu We Th Fr Sa Su Q-SystemP-System Q-SystemUpgrade* • Pre-Processing by Service Center • Regression testing of business processes • For customers not live on the P-System, configuration can continue once the Q-System has been successfully regression tested P-System Upgrade* The project schedule should include upgrade periods and post upgrade regression testing. • Transport Sprint Change Projects • Export Software Collection (ATO queue) *Q and P systems are not available during the upgrade for that system • Import Software Collection (ATO queue clear) • No Transports from Q to P • Production Go Live should not be scheduled in this period since no transports are possible
  • 45.
    46PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Landscape and Upgrades Upgrade Schedule *This is current state of planning and may be changed by SAP at any time without notice. All dates are proposed dates. • Quarterly upgrade is performed as follows: • S and Q is upgraded on the 1st weekend after RTC date. • P is upgraded on the 3rd weekend after RTC date. • Each customer is notified by email 6 weeks prior to the Q-System upgrade. • See the tasks in the Quarterly Release Cycle for more information on the upgrade process. This content will be reviewed prior to each quarterly update. • For important dates for Activation of new scope items, see Review and Request New Scope Activation. • For important dates for adding additional countries, see Extend Solution to Include a New Country.
  • 46.
    47PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Agenda Introduction to Cloud Trial Setup and Enablement Fit-to-Standard Scope and Configure Migration, Integrate, Extend and Test Deploy Operate, Monitor, and Support SAP Activate Apps and Enablement The Road to SAP S/4HANA Cloud with SAP Activate
  • 47.
    48PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Enablers for Your Digital Transformation SAP Activate Tools and Community SAP Activate Jam Community • Engage SAP Activate experts • Ask questions and collaborate • Stay up to date • Request access at http://bit.ly/SAPActivate SAP Roadmap Viewer • Browse implementation guidance for your digital transformation • Access SAP Activate methodology assets and accelerators • https://go.support.sap.com/roadmapv iewer/# SAP Best Practices Explorer • Access SAP Best Practices content • Power your project with ready-to-run processes • https://rapid.sap.com/bp/
  • 48.
    49PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Activate Methodology Training Curriculum Available to Customers, Partners and SAP Consultants Courses • ACT10e – Introduction to SAP Activate Methodology* • ACT200 – Agile Project Delivery (2 day classroom course) • ACT1CL – SAP Activate Methodology: Introduction (Cloud) • ACT2CL – SAP Activate Methodology: Cloud Implementation Certification • C_ACTIVATE05 – SAP Certified Associate - SAP Activate Project Manager * Also offered as classroom training ACT100
  • 49.
    50PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ “SAP has an Activate process which really helps takes those best practices and drives standardization, particularly for cloud.” “It’s really important that it’s a journey you want to go on from a change management perspective and that Activate Methodology really helped us sit down and look at our processes and then map to best practices and common business practices.” Kris Cowles, VP, Global Application IT, Topcon Corp. SAPPHIRE NOW 2018 Orlando, June 2018 Carrier discusses how SAP Activate guided them on their implementation journey – focusing on the fit-to-standard approach. “For us fit-to-standard meant that we could make a transformation, make a migration, convert the organization on to a standard that is continuously moving... we looked at it as a business transformation, the ability to say ‘what are the best practices,’adopting those from our partners – fitting our organization into those approaches and then being able to move forward in a rapid pace.” Scott Moore, Managing Director, Carrier Corp. SAPPHIRE NOW 2018 Orlando, June 2018 Proof Points: Customer Value and Key Differentiators with SAP Activate
  • 50.
    51PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ SAP Partners are Adopting SAP Activate in Their delivery “NTT DATA grew its SAP business during the past years massively to above 10,000 SAP people globally. Hereby, NTT DATA’s One Method plays the key role to providing highest quality in SAP implementation to employees and clients. The reason for success is owing to the great structure and content of SAP Activate, which NTT DATA continuously adopts to provide the best SAP standards to its people. SAP Activate has everything NTT DATA needs, because it covers the best expertise in S/4HANA and Cloud, and is being increasingly used for the new implementations, conversions, and transformations of our clients.” “We are lock step with SAP on their Activate journey which is designed to achieve value faster through the application of agile techniques.” “The release of SAP Activate has been perfectly timed for a market demanding the use of Rapid Deployment Solutions and deployed using Agile techniques. IBM has wholeheartedly embraced Activate and Agile within its own new IBM Ascend methodology and Impact Industry Solution. Our Clients have welcomed this new approach that generates faster speed to value under a lower risk delivery approach.” “Cognizant has been using the SAP Activate innovation adoption framework to accelerate many digital transformation programs for clients. The combination of Activate and Cognizant’s own hybrid agile methodology has helped us to take a programmatic approach that clients have welcomed because of the increased transparency, improved quality and agile infused adaptability it provides.” “SAP Activate formalizes the agile, lean, and DevOps approach Capgemini embraces to help clients achieve market leadership in the face of unrelenting change. That’s why we fully commit to the SAP Activate Framework — because we measure our value to clients by how fast, how often, and how well we help them innovate.” “T-Systems has been achieving best results for its customers by blending SAP Methodologies with its own. The SAP Activate innovation adoption framework has introduced a kick start method for total digital transformation. T-Systems offers its customers the best of both worlds for accelerated SAP S/4HANA implementations from end-to-end through the use of standardized transformation packages, agile methods and best practice. The tools and templates from the SAP Activate framework combined with T-Systems own SAP S/4HANA Transformation methodology reduces project risks and delivers faster customer success.”
  • 51.
    52PUBLIC© 2019 SAPSE or an SAP affiliate company. All rights reserved. ǀ Community benefits: ▪ Learn from our experts on various topics, gaining key insights, and stay up-to-date on the latest releases ▪ Webinars & events outlining the key topics which help organizations during project phases ▪ Open hours to engage live with our methodology experts ▪ Interactive collaboration with users regarding content, questions, and updates ▪ FREE access to the latest content to help organizations with projects Join our community today: http://bit.ly/SAPActivate Current members, access our community by clicking here SAP Activate Methodology Jam Group Join the Exclusive Community with the Latest Content on SAP Activate Methodology!
  • 52.
    Contact information: Jan Musil ChiefProduct Owner SAP Activate Methodology SAPActivateMethodology@sap.com Thank you.
