Lessons From the Field:
Aurora’s Approach to Sustainable Water Supply
Planning

Urban Water Sustainability Leadership
Conference

October 16, 2012
Lisa G. Darling, South Platte Program Manager

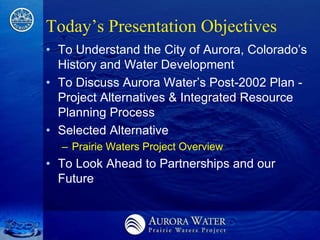

Today’s Presentation Objectives
• To Understand the City of Aurora, Colorado’s
  History and Water Development
• To Discuss Aurora Water’s Post-2002 Plan -
  Project Alternatives & Integrated Resource
  Planning Process
• Selected Alternative
  – Prairie Waters Project Overview
• To Look Ahead to Partnerships and our
  Future

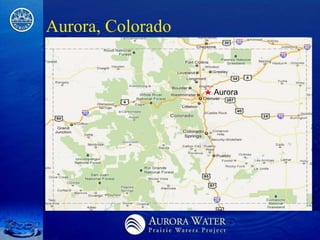

Aurora, Colorado

                   Aurora
City of Aurora, Colorado
• 3rd largest city in the state – for now
• Population 325,000 (2010 census)
• Home to Buckley Air Force Base and the
  Gateway to the Rockies!
Aurora’s History
• Founded in 1891, the city of Aurora was
originally named Fletcher by its founder,
former Chicago resident Donald Fletcher.

• 1929 - Colorado's Secretary of State recognized Aurora—with 2,000
residents—as a city, and tax revenues were appropriated for sewers,
roads and fire stations. Today, Aurora generates over $140 million in
revenues.

•1954 - Denver Water Board imposes a ―Blue Line‖ in the suburbs
beyond which it will no longer grant permits for new water taps. Parts of
Aurora fall out of the Denver Water Board service area.

•1958 - Aurora enters into an agreement with the City of Colorado
Springs to construct the ―Homestake Project,‖ designed to use water
rights purchased on the Western Slope and bring that water to the two
cities.

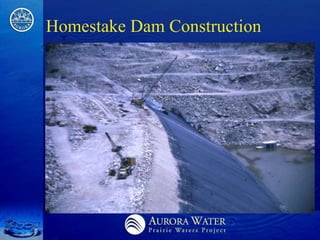

Homestake Dam Construction
• Photo of the homestake construction
  something historic…?

2002’s Water Supply Crisis

   26% of System Storage

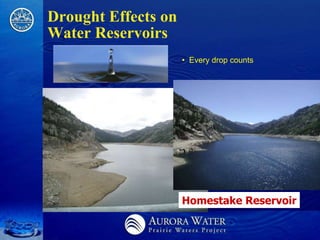

Drought Effects on
Water Reservoirs
                     • Every drop counts

                     Homestake Reservoir

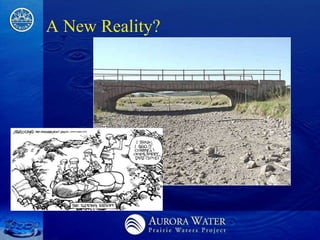

A New Reality?

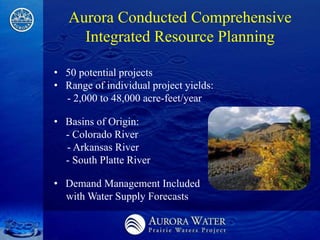

Aurora Conducted Comprehensive
     Integrated Resource Planning

• 50 potential projects
• Range of individual project yields:
  - 2,000 to 48,000 acre-feet/year

• Basins of Origin:
  - Colorado River
  - Arkansas River
  - South Platte River

• Demand Management Included
  with Water Supply Forecasts

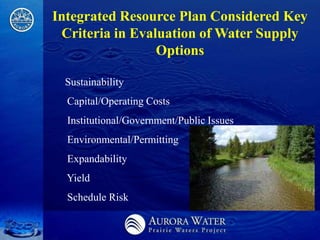

Integrated Resource Plan Considered Key
 Criteria in Evaluation of Water Supply
                 Options

 Sustainability
  Capital/Operating Costs
  Institutional/Government/Public Issues
  Environmental/Permitting
  Expandability
  Yield
  Schedule Risk
Prairie Waters Project – The Selected Alternative

   34 miles of 60-inch pipeline
   3 pumping stations
   North Campus (bank filtration and aquifer recharge and recovery)
   50-mgd water purification facility

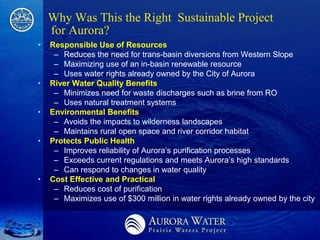

Why Was This the Right Sustainable Project
    for Aurora?
•   Responsible Use of Resources
     – Reduces the need for trans-basin diversions from Western Slope
     – Maximizing use of an in-basin renewable resource
     – Uses water rights already owned by the City of Aurora
•   River Water Quality Benefits
     – Minimizes need for waste discharges such as brine from RO
     – Uses natural treatment systems
•   Environmental Benefits
     – Avoids the impacts to wilderness landscapes
     – Maintains rural open space and river corridor habitat
•   Protects Public Health
     – Improves reliability of Aurora’s purification processes
     – Exceeds current regulations and meets Aurora’s high standards
     – Can respond to changes in water quality
•   Cost Effective and Practical
     – Reduces cost of purification
     – Maximizes use of $300 million in water rights already owned by the city
Prairie Waters Project Provides Drought Hardening
               and Meets Long-Term Capacity Needs
                                                    Today's System
                                                    Prairie Waters Project - Core Project
                                                    Prairie Waters Project (with Future Additions)
                                 130

                                 120
System Yield and System Demand

                                 110                                      105,500 AF/YR
      (1000's acre-feet/year)

                                 100

                                 90
                                                                     `

                                 80

                                 70                                                       65,500 AF/YR

                                 60

                                 50                                                                  55,500 AF/YR

                                 40
                                   2005   2010   2015    2020     2025     2030     2035      2040       2045       2050

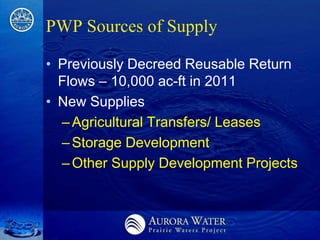

PWP Sources of Supply

• Previously Decreed Reusable Return
  Flows – 10,000 ac-ft in 2011
• New Supplies
  – Agricultural Transfers/ Leases
  – Storage Development
  – Other Supply Development Projects

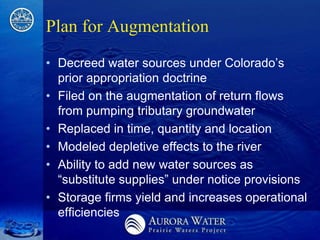

Plan for Augmentation
• Decreed water sources under Colorado’s
  prior appropriation doctrine
• Filed on the augmentation of return flows
  from pumping tributary groundwater
• Replaced in time, quantity and location
• Modeled depletive effects to the river
• Ability to add new water sources as
  ―substitute supplies‖ under notice provisions
• Storage firms yield and increases operational
  efficiencies

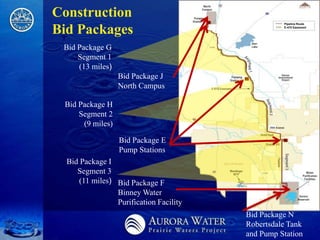

Construction
                                                   Pipeline Route

Bid Packages                                       E-470 Easement

 Bid Package G
     Segment 1
     (13 miles)
                  Bid Package J
                  North Campus

 Bid Package H
     Segment 2
      (9 miles)

                  Bid Package E
                  Pump Stations
  Bid Package I
     Segment 3
      (11 miles) Bid Package F
                 Binney Water
                 Purification Facility
                                         Bid Package N
                                         Robertsdale Tank
                                         and Pump Station
North Campus

17 riverbank
filtration wells
along the river.

                    Pilot testing of aquifer recharge
                    and recovery basins.

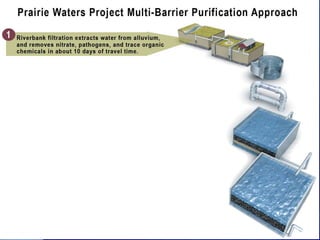

Prairie Waters Project

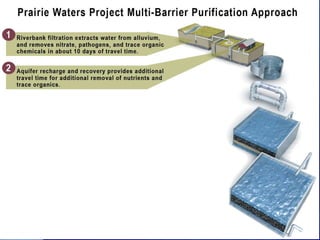

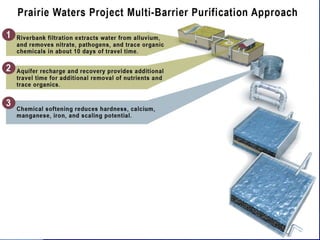

  Natural Purification Systems

Riverbank Filtration (RBF)
(10 days travel time)        Aquifer Recharge & Recovery (ARR)
                             (30 days travel time)

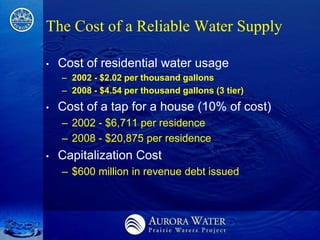

The Cost of a Reliable Water Supply

•   Cost of residential water usage
    – 2002 - $2.02 per thousand gallons
    – 2008 - $4.54 per thousand gallons (3 tier)
•   Cost of a tap for a house (10% of cost)
    – 2002 - $6,711 per residence
    – 2008 - $20,875 per residence
•   Capitalization Cost
    – $600 million in revenue debt issued

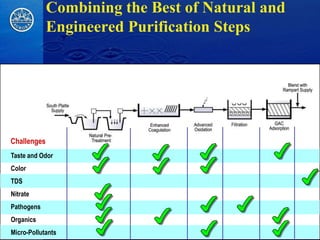

Combining the Best of Natural and
             Engineered Purification Steps

Challenges
Taste and Odor
Color
TDS
Nitrate
Pathogens
Organics
Micro-Pollutants

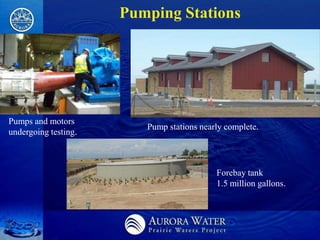

Pumping Stations

Pumps and motors
                         Pump stations nearly complete.
undergoing testing.

                                           Forebay tank
                                           1.5 million gallons.

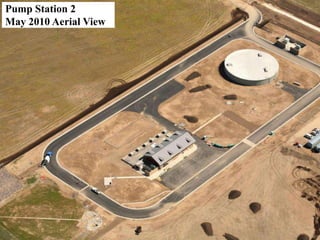

Pump Station 2
May 2010 Aerial View

Peter D. Binney Water Purification Facility

                                    Control building completed April 12.
Water being delivered to forebay.

   Building façades complete.                      Site overview.
Binney Water Purification Facility
May 2010 Aerial View                               Robertsdale Tank
                                                   and Pump Station

      Softening/                             Control
     Pretreatment                            Building
                                                        Flocculation/
                                                    Sedimentation Basins

                                                             Clearwell
                                                            Pump Station

      Ultraviolet
      Disinfection

                     Filtration/Adsorption
                                                        Chemical
                                                         Storage

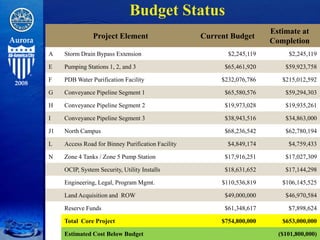

Budget Status
                                                                        Estimate at
                Project Element                     Current Budget
                                                                        Completion
A    Storm Drain Bypass Extension                          $2,245,119        $2,245,119

E    Pumping Stations 1, 2, and 3                         $65,461,920       $59,923,758

F    PDB Water Purification Facility                     $232,076,786      $215,012,592

G    Conveyance Pipeline Segment 1                        $65,580,576       $59,294,303

H    Conveyance Pipeline Segment 2                        $19,973,028       $19,935,261

I    Conveyance Pipeline Segment 3                        $38,943,516       $34,863,000

J1   North Campus                                         $68,236,542       $62,780,194

L    Access Road for Binney Purification Facility          $4,849,174        $4,759,433

N    Zone 4 Tanks / Zone 5 Pump Station                   $17,916,251       $17,027,309

     OCIP, System Security, Utility Installs              $18,631,652       $17,144,298

     Engineering, Legal, Program Mgmt.                   $110,536,819      $106,145,525

     Land Acquisition and ROW                             $49,000,000       $46,970,584

     Reserve Funds                                        $61,348,617        $7,898,624

     Total Core Project                                  $754,800,000      $653,000,000

     Estimated Cost Below Budget                                          ($101,800,000)

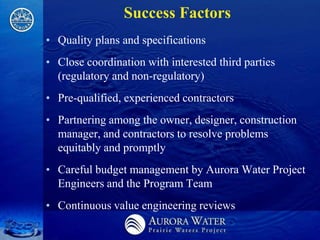

Success Factors
• Quality plans and specifications
• Close coordination with interested third parties
  (regulatory and non-regulatory)
• Pre-qualified, experienced contractors
• Partnering among the owner, designer, construction
  manager, and contractors to resolve problems
  equitably and promptly
• Careful budget management by Aurora Water Project
  Engineers and the Program Team
• Continuous value engineering reviews
Now what?

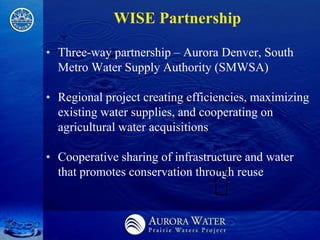

WISE Partnership

• Three-way partnership – Aurora Denver, South
  Metro Water Supply Authority (SMWSA)

• Regional project creating efficiencies, maximizing
  existing water supplies, and cooperating on
  agricultural water acquisitions

• Cooperative sharing of infrastructure and water
  that promotes conservation through reuse

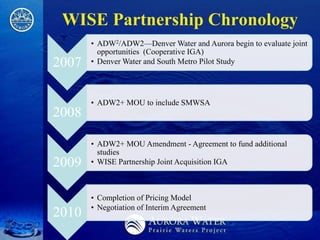

WISE Partnership Chronology
       • ADW2/ADW2—Denver Water and Aurora begin to evaluate joint
         opportunities (Cooperative IGA)
2007   • Denver Water and South Metro Pilot Study

       • ADW2+ MOU to include SMWSA
2008

       • ADW2+ MOU Amendment - Agreement to fund additional
         studies
2009   • WISE Partnership Joint Acquisition IGA

       • Completion of Pricing Model
       • Negotiation of Interim Agreement
2010
WISE Partnership

                         Metro WWTP

                            Denver      Aurora

                                                       Binney Water Purification Facility

                                                      Aurora Reservoir

        Conduit 27
                                           Potential WTP
                                           Rueter-Hess Reservoir
                     "

                     Foothills WTP
                                     South Metro
Hypothetical Wet, Normal and Dry Year Operations

      Wet Year                     Normal Year

                                    Dry Year / DW use of
                                          System

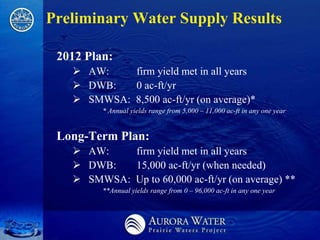

Preliminary Water Supply Results

 2012 Plan:
    AW:    firm yield met in all years
    DWB:   0 ac-ft/yr
    SMWSA: 8,500 ac-ft/yr (on average)*
         * Annual yields range from 5,000 – 11,000 ac-ft in any one year

 Long-Term Plan:
    AW:    firm yield met in all years
    DWB:   15,000 ac-ft/yr (when needed)
    SMWSA: Up to 60,000 ac-ft/yr (on average) **
         **Annual yields range from 0 – 96,000 ac-ft in any one year
WISE Joint Acquisition IGA
• In July 2009, Aurora Water, Denver Water
  and the South Metro Water Supply Authority
  entered into an Intergovernmental
  Agreement to facilitate the joint acquisition of
  water rights and development of water
  infrastructure, as part of the WISE
  Partnership process.
Goals?
• Provide a framework for sharing water acquisition and
  infrastructure opportunities within certain regions of the South
  Platte River basin.
• Encourage cost savings and other efficiencies with respect to
  the joint investigation and acquisition of water rights as well as
  the change of use for those water rights.
• Permit the joint development and use of water infrastructure
  facilities for a more efficient use (and reuse) of water within the
  participant's respective service areas.

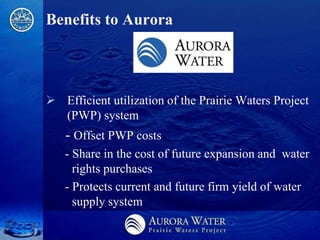

Benefits to Aurora

 Efficient utilization of the Prairie Waters Project
  (PWP) system
   - Offset PWP costs
   - Share in the cost of future expansion and water
     rights purchases
   - Protects current and future firm yield of water
     supply system

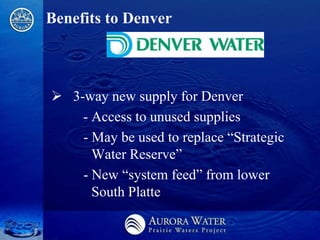

Benefits to Denver

 3-way new supply for Denver
    - Access to unused supplies
    - May be used to replace ―Strategic
      Water Reserve‖
    - New ―system feed‖ from lower
      South Platte

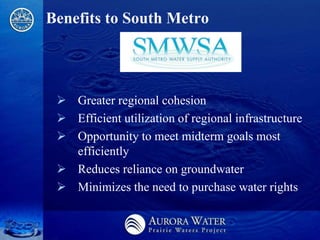

Benefits to South Metro

  Greater regional cohesion
  Efficient utilization of regional infrastructure
  Opportunity to meet midterm goals most
   efficiently
  Reduces reliance on groundwater
  Minimizes the need to purchase water rights

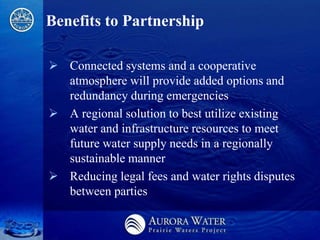

Benefits to Partnership

 Connected systems and a cooperative
  atmosphere will provide added options and
  redundancy during emergencies
 A regional solution to best utilize existing
  water and infrastructure resources to meet
  future water supply needs in a regionally
  sustainable manner
 Reducing legal fees and water rights disputes
  between parties
Strategic Planning Program
 • Long and short-range water resources
 planning
 • Planning support for the Basin Programs
 • Development and maintenance of planning
 models and tools
 • Regional planning
 • Integrated resources planning
 • CIP development – supplies, storage,
 conveyance/treatment
 • Demand forecasting / water conservation
Water Resources Planning Process
                            Existing
                            System

                 Finalize               Demand
                   CIP                 Projections

      Projects vs.                                  Identify
       Revenue                                     Shortages

                                        Identify
                Draft CIP
                                        Projects

                            Evaluate
                            Projects

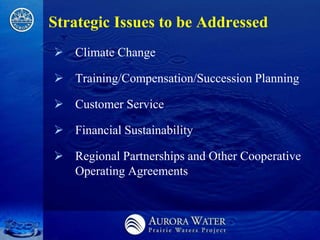

Strategic Issues to be Addressed
 Climate Change

 Training/Compensation/Succession Planning

 Customer Service

 Financial Sustainability

 Regional Partnerships and Other Cooperative
  Operating Agreements
Questions?

Please contact me at
ldarling@auroragov.org
(303) 739-7384
Peter J. Frost
          Executive Director
Douglasville-Douglas County
 Water and Sewer Authority
TIMETABLE OF EVENTS
o January 2004: Google acquires 101 Aquilla Way
 o August 2006: Google submits data center plans
    o September 2006: Data center plans approved
       o October 2006: Data center construction begins
           o December 2006: Re-use contract negotiations commence
               o August 2007: Data center operations commence
                  o December 2007: Google submits re-use plant plans
                      o January 2008: Re-use contract executed
                         o February 2008: Google re-use plans approved
                            o March 2008: Re-use plant construction begins
                                 o November 2008: WSA begins operations
                                       o October 2009: Project formally accepted
Contract Terms
 Confidentiality
 Initial construction
 Ownership
 Operation and maintenance
 Expansion
 Charges and fees
 Guarantees
MaryLynn
    Lodor,
Environmental
   Program
  Manager,
   MSDGC

                69
A new paradigm of urban drainage and used
water reuse with resource recovery needs to be
developed and implemented.

                                                 70
resource recovery: urban drainage

• View and Use Water as a
  Resource
• Integrated approaches
  (previously siloed) to
  technology, planning, policy,
  construction, economics, etc.
• Water in the urban
  environment must be
  approached as a single resource
  that can be continuously
  reused and recycled.

                                                       71
• 4 Rs – Reduce, Reclaim, Reuse, Restore
    – Reduce – water & energy conservation
    – Reclaim - Treat for safe discharge into environment &
      Reclaim energy (heat), nutrients
    – Reuse after additional treatment
    – Restore water bodies as a resource
•   3 Ss – Separate, Sequester and Store
    –   Separate Blue, White, Gray, Yellow & Black Water
    –   Sequester GHGs & remove/detoxify toxics
    –   Store reclaimed water on the surface or underground
•   2 Ts – Toilet to Tap
    –   Reclamation with or without 3Ss for potable reuse
MSD’s Operational System
                           resource recovery
Operational & Environmental Performance
                             resource recovery
resource recovery

• Fats, Oils & Grease Program
     Estimated 10 MG grease trap “waste”

    discharged into MSDGC annually.

• Working with University of Cincinnati to
characterize the content of trap grease
collected from WWTP

• Based on the oil content and the trap
grease production each year, the
estimated production of biodiesel could be
20,000 gallons/year.
   A new paradigm of urban drainage and used water reuse with resource
   recovery needs to be developed and implemented.
                                                                             75
water reuse

MetroWest Commerce
Park – Community
Development
industrial redevelopment
site, minutes from
downtown & adjacent to
Mill Creek WRF
                           Mill Creek Water
 ~18-acre clean           Reclamation
site/Ohio DOD approved
land for redevelopment     Facility
 Could be supplied with
industrial grade water
processed from
reclaimed wastewater.

           ⁄

                                              76

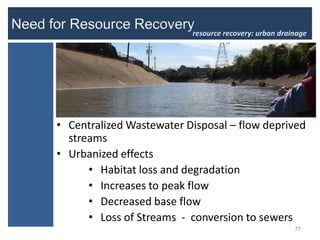

resource recovery: urban drainage

• Centralized Wastewater Disposal – flow deprived
  streams
• Urbanized effects
      • Habitat loss and degradation
      • Increases to peak flow
      • Decreased base flow
      • Loss of Streams - conversion to sewers
                                                       77
resource recovery: urban drainage
The goal is to manage the water so that an areas’ natural water
  balance is the same after development as it was before.

Next generation developments maximize the value
  of water:

   – Use water features to form or preserve the landscape, and as
     recreational and ecological preservation areas.
   – Incorporate water resource features that are aesthetically
     pleasing and serve a function in the water cycle.
   – Engineer features or restore or incorporate ponds, creeks and
     waterways otherwise into the urban design.

                                                               79
GOAL         resource recovery: urban drainage

Reduce stormwater inflow into the combined sewer
  system and out of the treatment plant
  • Locate streams, ditches, and swales that flow directly into
    the combined sewer system
  • Divert the flow to a “green” feature to help restore nature
    drainage and keep the water within the natural hydrologic
    cycle
• Waste reduction/ resource
 Direct            recovery
Impact           • Owned and operated by MSD
Projects           to support its core mission
                   • Remove liability of
                     stormwater

                        • Incorporate GI with public &
      Enabled             private partners
      Impact            • Bioinfiltration practices,
      Projects            green roofs, pervious/porous
                          paving

                 • Programmatic Elements to
                   support sustainable
                   infrastructure solutions
Inform &         • Integrated Planning
Influence        • Advisory Committee
                 • Community Engagement
CSO Contributions within Watershed
          Who contributes = who pays
                           /
                       ¼ acre =
Residential is         0.1MG/
contributing           annual
less than 1%
of the flow
tributary to
a CSO

Need for true                                             18 acre big box
costing to                        23 acre big box         16 MG/annual
incentivize                       21MG/annual
onsite
management                          Large Box Sites (2)
of reduced                           18 – 23 acre sites
inflow

                                                                     83
CSO Contributions within Watershed
          Who contributes = who pays
                           /
                                       ¼ acre =
Residential is                         0.1MG/
contributing                           annual
less than 1%
of the flow
tributary to
a CSO

Need for true                                                             15 acre big box
costing to       Water Billing based on           18 acre big box         16 MG/annual
incentivize   Consumption (cubic feet/month)      21MG/annual
onsite
management       ¼ acre w/ 1 bath     $22.33        Large Box Sites (2)
of reduced                                           15 – 18 acre sites
                      23 acres of
inflow              impervious &
                         6 toilets    $48.37
                      18 acres of
                  impervious & 6
                           toilets    $22.00
                                                                                     84
– Water conservation, reuse, and recycle
  reduces GHG emissions
– WWTPs –as renewable resource recovery
  facilities that produce clean water, recover e
  nergy and generate nutrients.

                                             85
86

Resource Recovery Panel

  • 1.
    Lessons From theField: Aurora’s Approach to Sustainable Water Supply Planning Urban Water Sustainability Leadership Conference October 16, 2012 Lisa G. Darling, South Platte Program Manager
  • 2.
    Today’s Presentation Objectives •To Understand the City of Aurora, Colorado’s History and Water Development • To Discuss Aurora Water’s Post-2002 Plan - Project Alternatives & Integrated Resource Planning Process • Selected Alternative – Prairie Waters Project Overview • To Look Ahead to Partnerships and our Future
  • 3.
  • 4.
    City of Aurora,Colorado • 3rd largest city in the state – for now • Population 325,000 (2010 census) • Home to Buckley Air Force Base and the Gateway to the Rockies!
  • 5.
    Aurora’s History • Foundedin 1891, the city of Aurora was originally named Fletcher by its founder, former Chicago resident Donald Fletcher. • 1929 - Colorado's Secretary of State recognized Aurora—with 2,000 residents—as a city, and tax revenues were appropriated for sewers, roads and fire stations. Today, Aurora generates over $140 million in revenues. •1954 - Denver Water Board imposes a ―Blue Line‖ in the suburbs beyond which it will no longer grant permits for new water taps. Parts of Aurora fall out of the Denver Water Board service area. •1958 - Aurora enters into an agreement with the City of Colorado Springs to construct the ―Homestake Project,‖ designed to use water rights purchased on the Western Slope and bring that water to the two cities.
  • 6.
    Homestake Dam Construction •Photo of the homestake construction something historic…?
  • 9.
    2002’s Water SupplyCrisis 26% of System Storage
  • 11.
    Drought Effects on WaterReservoirs • Every drop counts Homestake Reservoir
  • 12.
  • 13.
    Aurora Conducted Comprehensive Integrated Resource Planning • 50 potential projects • Range of individual project yields: - 2,000 to 48,000 acre-feet/year • Basins of Origin: - Colorado River - Arkansas River - South Platte River • Demand Management Included with Water Supply Forecasts
  • 14.
    Integrated Resource PlanConsidered Key Criteria in Evaluation of Water Supply Options Sustainability Capital/Operating Costs Institutional/Government/Public Issues Environmental/Permitting Expandability Yield Schedule Risk
  • 15.
    Prairie Waters Project– The Selected Alternative  34 miles of 60-inch pipeline  3 pumping stations  North Campus (bank filtration and aquifer recharge and recovery)  50-mgd water purification facility
  • 16.
    Why Was Thisthe Right Sustainable Project for Aurora? • Responsible Use of Resources – Reduces the need for trans-basin diversions from Western Slope – Maximizing use of an in-basin renewable resource – Uses water rights already owned by the City of Aurora • River Water Quality Benefits – Minimizes need for waste discharges such as brine from RO – Uses natural treatment systems • Environmental Benefits – Avoids the impacts to wilderness landscapes – Maintains rural open space and river corridor habitat • Protects Public Health – Improves reliability of Aurora’s purification processes – Exceeds current regulations and meets Aurora’s high standards – Can respond to changes in water quality • Cost Effective and Practical – Reduces cost of purification – Maximizes use of $300 million in water rights already owned by the city
  • 17.
    Prairie Waters ProjectProvides Drought Hardening and Meets Long-Term Capacity Needs Today's System Prairie Waters Project - Core Project Prairie Waters Project (with Future Additions) 130 120 System Yield and System Demand 110 105,500 AF/YR (1000's acre-feet/year) 100 90 ` 80 70 65,500 AF/YR 60 50 55,500 AF/YR 40 2005 2010 2015 2020 2025 2030 2035 2040 2045 2050
  • 18.
    PWP Sources ofSupply • Previously Decreed Reusable Return Flows – 10,000 ac-ft in 2011 • New Supplies – Agricultural Transfers/ Leases – Storage Development – Other Supply Development Projects
  • 19.
    Plan for Augmentation •Decreed water sources under Colorado’s prior appropriation doctrine • Filed on the augmentation of return flows from pumping tributary groundwater • Replaced in time, quantity and location • Modeled depletive effects to the river • Ability to add new water sources as ―substitute supplies‖ under notice provisions • Storage firms yield and increases operational efficiencies
  • 20.
    Construction Pipeline Route Bid Packages E-470 Easement Bid Package G Segment 1 (13 miles) Bid Package J North Campus Bid Package H Segment 2 (9 miles) Bid Package E Pump Stations Bid Package I Segment 3 (11 miles) Bid Package F Binney Water Purification Facility Bid Package N Robertsdale Tank and Pump Station
  • 21.
    North Campus 17 riverbank filtrationwells along the river. Pilot testing of aquifer recharge and recovery basins.
  • 22.
    Prairie Waters Project Natural Purification Systems Riverbank Filtration (RBF) (10 days travel time) Aquifer Recharge & Recovery (ARR) (30 days travel time)
  • 29.
    The Cost ofa Reliable Water Supply • Cost of residential water usage – 2002 - $2.02 per thousand gallons – 2008 - $4.54 per thousand gallons (3 tier) • Cost of a tap for a house (10% of cost) – 2002 - $6,711 per residence – 2008 - $20,875 per residence • Capitalization Cost – $600 million in revenue debt issued
  • 30.
    Combining the Bestof Natural and Engineered Purification Steps Challenges Taste and Odor Color TDS Nitrate Pathogens Organics Micro-Pollutants
  • 31.
    Pumping Stations Pumps andmotors Pump stations nearly complete. undergoing testing. Forebay tank 1.5 million gallons.
  • 32.
    Pump Station 2 May2010 Aerial View
  • 33.
    Peter D. BinneyWater Purification Facility Control building completed April 12. Water being delivered to forebay. Building façades complete. Site overview.
  • 34.
    Binney Water PurificationFacility May 2010 Aerial View Robertsdale Tank and Pump Station Softening/ Control Pretreatment Building Flocculation/ Sedimentation Basins Clearwell Pump Station Ultraviolet Disinfection Filtration/Adsorption Chemical Storage
  • 35.
    Budget Status Estimate at Project Element Current Budget Completion A Storm Drain Bypass Extension $2,245,119 $2,245,119 E Pumping Stations 1, 2, and 3 $65,461,920 $59,923,758 F PDB Water Purification Facility $232,076,786 $215,012,592 G Conveyance Pipeline Segment 1 $65,580,576 $59,294,303 H Conveyance Pipeline Segment 2 $19,973,028 $19,935,261 I Conveyance Pipeline Segment 3 $38,943,516 $34,863,000 J1 North Campus $68,236,542 $62,780,194 L Access Road for Binney Purification Facility $4,849,174 $4,759,433 N Zone 4 Tanks / Zone 5 Pump Station $17,916,251 $17,027,309 OCIP, System Security, Utility Installs $18,631,652 $17,144,298 Engineering, Legal, Program Mgmt. $110,536,819 $106,145,525 Land Acquisition and ROW $49,000,000 $46,970,584 Reserve Funds $61,348,617 $7,898,624 Total Core Project $754,800,000 $653,000,000 Estimated Cost Below Budget ($101,800,000)
  • 36.
    Success Factors • Qualityplans and specifications • Close coordination with interested third parties (regulatory and non-regulatory) • Pre-qualified, experienced contractors • Partnering among the owner, designer, construction manager, and contractors to resolve problems equitably and promptly • Careful budget management by Aurora Water Project Engineers and the Program Team • Continuous value engineering reviews
  • 37.
  • 38.
    WISE Partnership • Three-waypartnership – Aurora Denver, South Metro Water Supply Authority (SMWSA) • Regional project creating efficiencies, maximizing existing water supplies, and cooperating on agricultural water acquisitions • Cooperative sharing of infrastructure and water that promotes conservation through reuse
  • 39.
    WISE Partnership Chronology • ADW2/ADW2—Denver Water and Aurora begin to evaluate joint opportunities (Cooperative IGA) 2007 • Denver Water and South Metro Pilot Study • ADW2+ MOU to include SMWSA 2008 • ADW2+ MOU Amendment - Agreement to fund additional studies 2009 • WISE Partnership Joint Acquisition IGA • Completion of Pricing Model • Negotiation of Interim Agreement 2010
  • 40.
    WISE Partnership Metro WWTP Denver Aurora Binney Water Purification Facility Aurora Reservoir Conduit 27 Potential WTP Rueter-Hess Reservoir " Foothills WTP South Metro
  • 41.
    Hypothetical Wet, Normaland Dry Year Operations Wet Year Normal Year Dry Year / DW use of System
  • 42.
    Preliminary Water SupplyResults 2012 Plan:  AW: firm yield met in all years  DWB: 0 ac-ft/yr  SMWSA: 8,500 ac-ft/yr (on average)* * Annual yields range from 5,000 – 11,000 ac-ft in any one year Long-Term Plan:  AW: firm yield met in all years  DWB: 15,000 ac-ft/yr (when needed)  SMWSA: Up to 60,000 ac-ft/yr (on average) ** **Annual yields range from 0 – 96,000 ac-ft in any one year
  • 43.
    WISE Joint AcquisitionIGA • In July 2009, Aurora Water, Denver Water and the South Metro Water Supply Authority entered into an Intergovernmental Agreement to facilitate the joint acquisition of water rights and development of water infrastructure, as part of the WISE Partnership process.
  • 44.
    Goals? • Provide aframework for sharing water acquisition and infrastructure opportunities within certain regions of the South Platte River basin. • Encourage cost savings and other efficiencies with respect to the joint investigation and acquisition of water rights as well as the change of use for those water rights. • Permit the joint development and use of water infrastructure facilities for a more efficient use (and reuse) of water within the participant's respective service areas.
  • 45.
    Benefits to Aurora Efficient utilization of the Prairie Waters Project (PWP) system - Offset PWP costs - Share in the cost of future expansion and water rights purchases - Protects current and future firm yield of water supply system
  • 46.
    Benefits to Denver 3-way new supply for Denver - Access to unused supplies - May be used to replace ―Strategic Water Reserve‖ - New ―system feed‖ from lower South Platte
  • 47.
    Benefits to SouthMetro  Greater regional cohesion  Efficient utilization of regional infrastructure  Opportunity to meet midterm goals most efficiently  Reduces reliance on groundwater  Minimizes the need to purchase water rights
  • 48.
    Benefits to Partnership Connected systems and a cooperative atmosphere will provide added options and redundancy during emergencies  A regional solution to best utilize existing water and infrastructure resources to meet future water supply needs in a regionally sustainable manner  Reducing legal fees and water rights disputes between parties
  • 49.
    Strategic Planning Program • Long and short-range water resources planning • Planning support for the Basin Programs • Development and maintenance of planning models and tools • Regional planning • Integrated resources planning • CIP development – supplies, storage, conveyance/treatment • Demand forecasting / water conservation
  • 50.
    Water Resources PlanningProcess Existing System Finalize Demand CIP Projections Projects vs. Identify Revenue Shortages Identify Draft CIP Projects Evaluate Projects
  • 51.
    Strategic Issues tobe Addressed  Climate Change  Training/Compensation/Succession Planning  Customer Service  Financial Sustainability  Regional Partnerships and Other Cooperative Operating Agreements
  • 53.
    Questions? Please contact meat ldarling@auroragov.org (303) 739-7384
  • 54.
    Peter J. Frost Executive Director Douglasville-Douglas County Water and Sewer Authority
  • 66.
    TIMETABLE OF EVENTS oJanuary 2004: Google acquires 101 Aquilla Way o August 2006: Google submits data center plans o September 2006: Data center plans approved o October 2006: Data center construction begins o December 2006: Re-use contract negotiations commence o August 2007: Data center operations commence o December 2007: Google submits re-use plant plans o January 2008: Re-use contract executed o February 2008: Google re-use plans approved o March 2008: Re-use plant construction begins o November 2008: WSA begins operations o October 2009: Project formally accepted
  • 67.
    Contract Terms  Confidentiality Initial construction  Ownership  Operation and maintenance  Expansion  Charges and fees  Guarantees
  • 68.
    MaryLynn Lodor, Environmental Program Manager, MSDGC 69
  • 69.
    A new paradigmof urban drainage and used water reuse with resource recovery needs to be developed and implemented. 70
  • 70.
    resource recovery: urbandrainage • View and Use Water as a Resource • Integrated approaches (previously siloed) to technology, planning, policy, construction, economics, etc. • Water in the urban environment must be approached as a single resource that can be continuously reused and recycled. 71
  • 71.
    • 4 Rs– Reduce, Reclaim, Reuse, Restore – Reduce – water & energy conservation – Reclaim - Treat for safe discharge into environment & Reclaim energy (heat), nutrients – Reuse after additional treatment – Restore water bodies as a resource • 3 Ss – Separate, Sequester and Store – Separate Blue, White, Gray, Yellow & Black Water – Sequester GHGs & remove/detoxify toxics – Store reclaimed water on the surface or underground • 2 Ts – Toilet to Tap – Reclamation with or without 3Ss for potable reuse
  • 72.
    MSD’s Operational System resource recovery
  • 73.
    Operational & EnvironmentalPerformance resource recovery
  • 74.
    resource recovery • Fats,Oils & Grease Program  Estimated 10 MG grease trap “waste” discharged into MSDGC annually. • Working with University of Cincinnati to characterize the content of trap grease collected from WWTP • Based on the oil content and the trap grease production each year, the estimated production of biodiesel could be 20,000 gallons/year. A new paradigm of urban drainage and used water reuse with resource recovery needs to be developed and implemented. 75
  • 75.
    water reuse MetroWest Commerce Park– Community Development industrial redevelopment site, minutes from downtown & adjacent to Mill Creek WRF Mill Creek Water  ~18-acre clean Reclamation site/Ohio DOD approved land for redevelopment Facility  Could be supplied with industrial grade water processed from reclaimed wastewater. ⁄ 76
  • 76.
    resource recovery: urbandrainage • Centralized Wastewater Disposal – flow deprived streams • Urbanized effects • Habitat loss and degradation • Increases to peak flow • Decreased base flow • Loss of Streams - conversion to sewers 77
  • 78.
    resource recovery: urbandrainage The goal is to manage the water so that an areas’ natural water balance is the same after development as it was before. Next generation developments maximize the value of water: – Use water features to form or preserve the landscape, and as recreational and ecological preservation areas. – Incorporate water resource features that are aesthetically pleasing and serve a function in the water cycle. – Engineer features or restore or incorporate ponds, creeks and waterways otherwise into the urban design. 79
  • 79.
    GOAL resource recovery: urban drainage Reduce stormwater inflow into the combined sewer system and out of the treatment plant • Locate streams, ditches, and swales that flow directly into the combined sewer system • Divert the flow to a “green” feature to help restore nature drainage and keep the water within the natural hydrologic cycle
  • 80.
    • Waste reduction/resource Direct recovery Impact • Owned and operated by MSD Projects to support its core mission • Remove liability of stormwater • Incorporate GI with public & Enabled private partners Impact • Bioinfiltration practices, Projects green roofs, pervious/porous paving • Programmatic Elements to support sustainable infrastructure solutions Inform & • Integrated Planning Influence • Advisory Committee • Community Engagement
  • 82.
    CSO Contributions withinWatershed Who contributes = who pays / ¼ acre = Residential is 0.1MG/ contributing annual less than 1% of the flow tributary to a CSO Need for true 18 acre big box costing to 23 acre big box 16 MG/annual incentivize 21MG/annual onsite management Large Box Sites (2) of reduced 18 – 23 acre sites inflow 83
  • 83.
    CSO Contributions withinWatershed Who contributes = who pays / ¼ acre = Residential is 0.1MG/ contributing annual less than 1% of the flow tributary to a CSO Need for true 15 acre big box costing to Water Billing based on 18 acre big box 16 MG/annual incentivize Consumption (cubic feet/month) 21MG/annual onsite management ¼ acre w/ 1 bath $22.33 Large Box Sites (2) of reduced 15 – 18 acre sites 23 acres of inflow impervious & 6 toilets $48.37 18 acres of impervious & 6 toilets $22.00 84
  • 84.
    – Water conservation,reuse, and recycle reduces GHG emissions – WWTPs –as renewable resource recovery facilities that produce clean water, recover e nergy and generate nutrients. 85
  • 85.

Editor's Notes

  • #70 I want to give a perspective about RR from the perspective of a ww utility, charged with improving water quality throughout our service area. However, there are numerous water quality challenges to recovery of the resource that necessitate a new approach because the way we have historically solved “problems” needs a broader, more integrated approach. Settle near rivers and commerce More people, more wasteDecisions have caused liabiilty in urban waters800 communities face CSOsFlooding impacts of traditional solutionsValue of Water Natural resources that provide ecological servicesAquatic LifeEnvironmental HealthCommunity Health and Vitality
  • #71 The LR watershed is one of our largest CSOs; it is also a very steep sloping watershed and drainage area with large volumes of flow entering through entry points into the Combined. Through the analysis, MSD has partnered with other public planning agencies and organizations to evaluate the existing conditinso within the community Urban Audits - building conditions Existing land use – natural and built environment Historical and cultural reviews Community transportation planning Existing Assets condition assessmentBrownfields assessments Enabled Impact assessmentsConsideration for using the existing conditions as opportunities to reduce CSOs through an integrated watershed evaluation – a process we have developed and refined for other watersheds
  • #73 http://www.aquanovallc.com/wp-content/uploads/2011/04/Closing-the-Water-Cycle-for-pdf.pdf
  • #76 Resource Recovery is not a new topic for the environmental field. However, it has historically be linked to solid waste management or energy systems. Traditional wastewater treatment faciltiies have historically been designed to treat flow to certain quality and then discharge or dispose of the end produce as treated effluent or biosolids. The approach of centralized WWTP have left many urban streams FLOW DEPPRIVED. Without flow, urban waters suffer from lack of base flow as well as other urban effects of hatitat loss, degradation, and loss of streams to sewers.
  • #77 Resource Recovery is not a new topic for the environmental field. However, it has historically be linked to solid waste management or energy systems. Traditional wastewater treatment faciltiies have historically been designed to treat flow to certain quality and then discharge or dispose of the end produce as treated effluent or biosolids. The approach of centralized WWTP have left many urban streams FLOW DEPPRIVED. Without flow, urban waters suffer from lack of base flow as well as other urban effects of hatitat loss, degradation, and loss of streams to sewers.
  • #78 Resource Recovery is not a new topic for the environmental field. However, it has historically be linked to solid waste management or energy systems. Traditional wastewater treatment faciltiies have historically been designed to treat flow to certain quality and then discharge or dispose of the end produce as treated effluent or biosolids. The approach of centralized WWTP have left many urban streams FLOW DEPPRIVED. Without flow, urban waters suffer from lack of base flow as well as other urban effects of hatitat loss, degradation, and loss of streams to sewers.
  • #79 The Lower Mill Creek watershed previously had a network of natural streams and waterbodies that included over 300 miles of streams.The urbanization of Cincinnati resulted in many great developments. Modification of the drainage network and sending much of our streams to the sewer was not one of the better foundations previous generations laid for us. MSD faces significant challenges as it implements mandated solutions to reduce the overflows at the end-of-the-pipe. As we begin designing solutions to reduce CSO discharges in the Lower Mill Creek, we are looking for ways to remove stormwater from the sewer network. Much of the problem stems from the channelization of rivers and stream that dates back to the late 1800s.
  • #80 The LR watershed is one of our largest CSOs; it is also a very steep sloping watershed and drainage area with large volumes of flow entering through entry points into the Combined. Through the analysis, MSD has partnered with other public planning agencies and organizations to evaluate the existing conditinso within the community Urban Audits - building conditions Existing land use – natural and built environment Historical and cultural reviews Community transportation planning Existing Assets condition assessmentBrownfields assessments Enabled Impact assessmentsConsideration for using the existing conditions as opportunities to reduce CSOs through an integrated watershed evaluation – a process we have developed and refined for other watersheds
  • #82 Removal of natural drainage and stormwater from entering the combined systemNumber of Projects – 36Anticipated annual stormwater runoff capture volume – 70 million gallons1Program-wide statistics:318,000 square feet of bioinfiltration practices169,000 square feet of green roofs161,000 square feet of pervious/porous paving125,000 gallons of rainwater harvesting storage space
  • #83 Early Lick Run watershed evaluations focused on a site BMPS (e.g., rain barrels, driveways, etc.). These were not effective strategies for achieving mandated CSO volume reductions.But through anintegrated watershed approach , MSD has since developed a detailed SWEP process to develop and consider watershed based CSO reduction solutions using numerous large, regional and small scale CSO reduction strategies – including the use of a Tiered system of direct and indirect projects.
  • #86 The LR watershed is one of our largest CSOs; it is also a very steep sloping watershed and drainage area with large volumes of flow entering through entry points into the Combined. Through the analysis, MSD has partnered with other public planning agencies and organizations to evaluate the existing conditinso within the community Urban Audits - building conditions Existing land use – natural and built environment Historical and cultural reviews Community transportation planning Existing Assets condition assessmentBrownfields assessments Enabled Impact assessmentsConsideration for using the existing conditions as opportunities to reduce CSOs through an integrated watershed evaluation – a process we have developed and refined for other watersheds
  • #87 2BG vs. 1.2 BG1. This is a legal issue for the Co-Defendants to consider. 2.Regulators stated “they want something significant in Lower Mill Creek”. The 2 BG removal represents a significant reduction and satisfies the expectation of USEPA and Ohio EPA. EPA has never waivered off the 2 BG removal. The affordability issue drove the Phase 1 program and was based upon a 2BG reduction.If the Regulators had the updated model information during development of the WWIP, then they would have likely required a full basin remedy early in lieu of our phased approach. More projects would have been included into early action requirements – under our Phase 1.If we had presented the sustainable approach to USEPA during WWIP negotiations, the Phase 1 WWIP would have been very different and would not have included a tunnel.During WWIP negotiations, we tried to reduce the overall total program spending requirement. Even if we approach them with a lower cost Phase 1 remedy, the long-term cost of this Program will not be reduced.Our strategy is to lead with sustainable so the grey components can be right-sized. Sustainable provides the Co-Defendants the flexibility to
