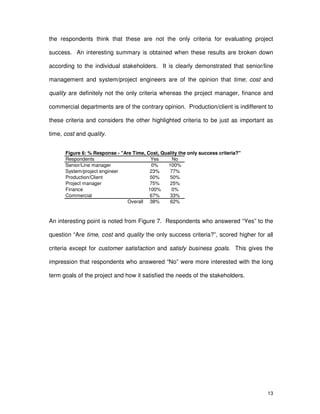

This document discusses project success criteria for engineering and refurbishment projects at Eskom, a South African power utility. It conducted a survey of stakeholders to identify key success criteria. The survey found that while time, cost and quality were important, other factors like satisfying business goals, customer satisfaction, and impact on plant were rated as even more important. Different stakeholders had differing views, with clients prioritizing satisfying goals, customer satisfaction and impact, while project managers prioritized quality, time and cost. Most respondents felt that time, cost and quality were not the only important success criteria. The document concludes that multiple factors are important for measuring project success.
