This document provides an overview of the ProTech program, which acquires professional and technical services for NOAA efficiently and effectively through indefinite delivery/indefinite quantity contracts. Key points:
- ProTech consists of multiple IDIQ contracts across five domains (Professional & Technical Services) that are competed at the task order level.
- Task orders are issued to large and small businesses under the contracts. A 3% fee is charged for use of ProTech.
- The document outlines the task order processes, which can be traditional (proposals to all contractors), multiphase (downselect), and roles/responsibilities of contracting staff.
- The goal is to streamline acquisition, achieve cost savings,
RFP1. Project Initiation Phase The purpose of the RFP document.docxhealdkathaleen
RFP
1. Project Initiation Phase
The purpose of the RFP document is to define all procurement related activities for implementing Oracle for Tesla motors. This document will outline all the procurement management activities and resources that are required for implementing the software.
2. Procurement Statement
Below are the list of items that must be procured in order to successfully start the project.
Item/Service
Justification
Needed By
Cost
Rack server for the software implementation
This is an inventory item that needs to be procured for implementing the new software (Oracle R12) for the company
01/01/2018
$5000
Printer and scanner
Need printer/ scan to print out the documentation
01/5/2018
$2000
Table
Need computer tables for consultants to work on implementation
01/15/2018
$1000
Chair
Need desk chairs for consultants to implement the application
01/15/2018
$1000
Car
Need a car for consultant’s usage
01/15/2018
$10,000
Laptops
Laptops are needed for consultants to work on
01/15/2018
$5000
Office supplies
These are office supplies that are required by the implementation partner
01/15/2018
$2000
Consultants service
Consultant service is required to implement the Oracle software.
01/15/2018
$404,617.60
Vendor selection: The vendor selection process is very straight forward as most of the vendors are have had good relations with real tech. The entire consultant team are offered by Real Tech itself. The office supplies are procured by the vendor name Staples. Finally, the laptops are procured by tech systems. The vendors are carefully analyzed by the buyers and are listed on the buyer’s approved vendor list of vendors. The vendors are rated based on the price, delivery time and quality of the products.
3. Selection Process & Criteria
The hardware and office supplies are based on the planned purchase order contract with the vendor. The consultants are interviewed before hand before onboarding the resources into the team.
4. Project Procurement Team
All procurement activities must initially get approval from the immediate manager and then the approval of the project manager. The project manager must document justify the need in a form of a document and present it to the project sponsors.
5.Contract Type:
The procurement strategy used by Tesla is called Fixed- Price Contract. This type of contract is also called Lump- sum contract. The reason for choosing this contract is that there is no uncertainty in the scope of the project. The purchasing module in the Oracle ERP software will help improve the procure to pay cycle in the organization. The ERP implementation partner is bound to finish the implementation within one year at the cost of $350,000.
6.Contract Standards:
All procurement must follow the ISO 9001:2015 standards.
7.Vandor Management/ Perforance
This section describes the metrics to be used for procurement activities associated with the project. These metrics may include but not be limited to: methods to ensure the p ...
RFP1. Project Initiation Phase The purpose of the RFP document.docxhealdkathaleen
RFP
1. Project Initiation Phase
The purpose of the RFP document is to define all procurement related activities for implementing Oracle for Tesla motors. This document will outline all the procurement management activities and resources that are required for implementing the software.
2. Procurement Statement
Below are the list of items that must be procured in order to successfully start the project.
Item/Service
Justification
Needed By
Cost
Rack server for the software implementation
This is an inventory item that needs to be procured for implementing the new software (Oracle R12) for the company
01/01/2018
$5000
Printer and scanner
Need printer/ scan to print out the documentation
01/5/2018
$2000
Table
Need computer tables for consultants to work on implementation
01/15/2018
$1000
Chair
Need desk chairs for consultants to implement the application
01/15/2018
$1000
Car
Need a car for consultant’s usage
01/15/2018
$10,000
Laptops
Laptops are needed for consultants to work on
01/15/2018
$5000
Office supplies
These are office supplies that are required by the implementation partner
01/15/2018
$2000
Consultants service
Consultant service is required to implement the Oracle software.
01/15/2018
$404,617.60
Vendor selection: The vendor selection process is very straight forward as most of the vendors are have had good relations with real tech. The entire consultant team are offered by Real Tech itself. The office supplies are procured by the vendor name Staples. Finally, the laptops are procured by tech systems. The vendors are carefully analyzed by the buyers and are listed on the buyer’s approved vendor list of vendors. The vendors are rated based on the price, delivery time and quality of the products.
3. Selection Process & Criteria
The hardware and office supplies are based on the planned purchase order contract with the vendor. The consultants are interviewed before hand before onboarding the resources into the team.
4. Project Procurement Team
All procurement activities must initially get approval from the immediate manager and then the approval of the project manager. The project manager must document justify the need in a form of a document and present it to the project sponsors.
5.Contract Type:
The procurement strategy used by Tesla is called Fixed- Price Contract. This type of contract is also called Lump- sum contract. The reason for choosing this contract is that there is no uncertainty in the scope of the project. The purchasing module in the Oracle ERP software will help improve the procure to pay cycle in the organization. The ERP implementation partner is bound to finish the implementation within one year at the cost of $350,000.
6.Contract Standards:
All procurement must follow the ISO 9001:2015 standards.
7.Vandor Management/ Perforance
This section describes the metrics to be used for procurement activities associated with the project. These metrics may include but not be limited to: methods to ensure the p ...
E governance project conceptualisation to implementationAnirban Mukerji
The enclosed presentation highlights the various aspects related to conceptualisation of e-Governance projects including what aspects comprise a DPR and RFP
•Over 10 years of professional experience, as expert procurement professional, inventory controlling, and overseas operation.
•Participated in developing tender and contract policies according to Abu Dhabi procurement regulations 2008, Article NO.6 to improve business performance and cut cost.
•Involved in Re-engineering Procurement Process and Procedures.
•Manage multiple projects, and budget controlling.
•Suppliers sourcing & negotiation skills. Contracts performance evaluation & raw material planning.
•High potential communication and analytic skills.
Possible suggestions and overview on Procurement process streamlining.pptxabiytk
Suggestive slides presented as part my recruitment with the objective to designing a customized and an all new Procurement Directive for the newly established Construction Business Unit within the overarching Ethiopian Engineering and Investment Group (EEIG), a state-owned corporation having 8 business units being restructured to forming a holding company.
Equipment finance systems project guide 101David Pedreno
Equipment Finance Systems Project Guide 101" Second edition. You are starting, or have already started, an equipment finance and leasing system implementation. What are the typical pain points ahead?
In this “101" guide and tips, Richmond Group looks at the key areas that will need attention if the journey is to be a smooth one. We hope our tips help you get your project off to a good start and welcome any comments!
Equipment finance systems project guide "101"David Pedreno
Equipment Finance Systems Project Guide "101" Second edition. You are starting, or have already started, an equipment finance and leasing system implementation. What are the typical pain points ahead?
In this “101" guide and tips, Richmond Group looks at the key areas that will need attention if the journey is to be a smooth one. We hope our tips help you get your project off to a good start and welcome any comments!
Equipment Finance Systems Project Guide 101" Second edition. You are starting, or have already started, an equipment finance and leasing system implementation. What are the typical pain points ahead?
In this “101" guide and tips, Richmond Group looks at the key areas that will need attention if the journey is to be a smooth one. We hope our tips help you get your project off to a good start and welcome any comments!
Tata Group Dials Taiwan for Its Chipmaking Ambition in Gujarat’s DholeraAvirahi City Dholera
The Tata Group, a titan of Indian industry, is making waves with its advanced talks with Taiwanese chipmakers Powerchip Semiconductor Manufacturing Corporation (PSMC) and UMC Group. The goal? Establishing a cutting-edge semiconductor fabrication unit (fab) in Dholera, Gujarat. This isn’t just any project; it’s a potential game changer for India’s chipmaking aspirations and a boon for investors seeking promising residential projects in dholera sir.
Visit : https://www.avirahi.com/blog/tata-group-dials-taiwan-for-its-chipmaking-ambition-in-gujarats-dholera/
LA HUG - Video Testimonials with Chynna Morgan - June 2024Lital Barkan
Have you ever heard that user-generated content or video testimonials can take your brand to the next level? We will explore how you can effectively use video testimonials to leverage and boost your sales, content strategy, and increase your CRM data.🤯
We will dig deeper into:
1. How to capture video testimonials that convert from your audience 🎥
2. How to leverage your testimonials to boost your sales 💲
3. How you can capture more CRM data to understand your audience better through video testimonials. 📊
Top mailing list providers in the USA.pptxJeremyPeirce1
Discover the top mailing list providers in the USA, offering targeted lists, segmentation, and analytics to optimize your marketing campaigns and drive engagement.
FIA officials brutally tortured innocent and snatched 200 Bitcoins of worth 4...jamalseoexpert1978
Farman Ayaz Khattak and Ehtesham Matloob are government officials in CTW Counter terrorism wing Islamabad, in Federal Investigation Agency FIA Headquarters. CTW and FIA kidnapped crypto currency owner from Islamabad and snatched 200 Bitcoins those worth of 4 billion rupees in Pakistan currency. There is not Cryptocurrency Regulations in Pakistan & CTW is official dacoit and stealing digital assets from the innocent crypto holders and making fake cases of terrorism to keep them silent.
Implicitly or explicitly all competing businesses employ a strategy to select a mix
of marketing resources. Formulating such competitive strategies fundamentally
involves recognizing relationships between elements of the marketing mix (e.g.,
price and product quality), as well as assessing competitive and market conditions
(i.e., industry structure in the language of economics).
Premium MEAN Stack Development Solutions for Modern BusinessesSynapseIndia
Stay ahead of the curve with our premium MEAN Stack Development Solutions. Our expert developers utilize MongoDB, Express.js, AngularJS, and Node.js to create modern and responsive web applications. Trust us for cutting-edge solutions that drive your business growth and success.
Know more: https://www.synapseindia.com/technology/mean-stack-development-company.html
Anny Serafina Love - Letter of Recommendation by Kellen Harkins, MS.AnnySerafinaLove
This letter, written by Kellen Harkins, Course Director at Full Sail University, commends Anny Love's exemplary performance in the Video Sharing Platforms class. It highlights her dedication, willingness to challenge herself, and exceptional skills in production, editing, and marketing across various video platforms like YouTube, TikTok, and Instagram.
buy old yahoo accounts buy yahoo accountsSusan Laney
As a business owner, I understand the importance of having a strong online presence and leveraging various digital platforms to reach and engage with your target audience. One often overlooked yet highly valuable asset in this regard is the humble Yahoo account. While many may perceive Yahoo as a relic of the past, the truth is that these accounts still hold immense potential for businesses of all sizes.
B2B payments are rapidly changing. Find out the 5 key questions you need to be asking yourself to be sure you are mastering B2B payments today. Learn more at www.BlueSnap.com.
Discover the innovative and creative projects that highlight my journey throu...dylandmeas
Discover the innovative and creative projects that highlight my journey through Full Sail University. Below, you’ll find a collection of my work showcasing my skills and expertise in digital marketing, event planning, and media production.
Understanding User Needs and Satisfying ThemAggregage
https://www.productmanagementtoday.com/frs/26903918/understanding-user-needs-and-satisfying-them
We know we want to create products which our customers find to be valuable. Whether we label it as customer-centric or product-led depends on how long we've been doing product management. There are three challenges we face when doing this. The obvious challenge is figuring out what our users need; the non-obvious challenges are in creating a shared understanding of those needs and in sensing if what we're doing is meeting those needs.
In this webinar, we won't focus on the research methods for discovering user-needs. We will focus on synthesis of the needs we discover, communication and alignment tools, and how we operationalize addressing those needs.
Industry expert Scott Sehlhorst will:
• Introduce a taxonomy for user goals with real world examples
• Present the Onion Diagram, a tool for contextualizing task-level goals
• Illustrate how customer journey maps capture activity-level and task-level goals
• Demonstrate the best approach to selection and prioritization of user-goals to address
• Highlight the crucial benchmarks, observable changes, in ensuring fulfillment of customer needs
3. WHAT IS PROTECH?
Specific requirements competed at the task order level
in each of five mission domains
(Professional & Technical Services)
ProTech is a strategic sourcing program to
acquire professional and technical services
efficiently and effectively to meet the
mission of NOAA.
ProTech consists of a set of Indefinite Delivery /
Indefinite Quantity (IDIQ) Contracts in five separate
domains awarded to large and small businesses.
Awards made based on full and open competition
with “Reserves” for small business
Mandatory use program with a 3% ProTech fee for
service.
4. ACQUISITION PROFILE
0
1
2
3
1 2 3 4 5
YEARS
BILLIONS
YEAR
BASE
1-YEAR
OPTIONS
Multiple Award – Indefinite Delivery, Indefinite
Quantity (IDIQ) Contracts
Task Order Types - Time & Materials, Firm Fixed
Price, and Cost Reimbursable
o $2.5 B (historical trend with escalation)
o $0.5 B for Growth and Department of Commerce utilization
$3B
5YR
with
5. AUTHORIZED CLIENTS
All NOAA Line and Staff offices
Other Department of Commerce Bureaus
Decentralized ordering (ordering at the Staff
and Line local level)
ProTech is not a Government-Wide Acquisition
Contract (GWAC) and cannot be used by
other Federal agencies.
6. STRATEGIC
SOURCING
ACQUISITION
DIVISION
PROTECH
OVERVIEW
GENERAL
CONTRACT
MANAGEMENT
TASK-ORDER –
ORDERING
PROCEDURES
QUESTIONS
SSAD serves as the Program Office with oversight for the
execution of the ProTech contract vehicles.
The ProTech Branch within SSAD will use the ProTech Program Office and
portfolio of contracts to:
o Provide guidance and assistance to clients who use ProTech contracts;
o Ensure that clients are aware of their responsibilities and the scope of
the ProTech contracts;
o Address and satisfy the needs of all participants in the acquisition
process;
o Maintain a level of contract and program integrity that prevents or
mitigates contractual or programmatic problems and risks; and
o Solicit feedback and provide continuous process improvement.
7. BENEFITSOBJECTIVES
Delivery of top quality, performance-based services and
solutions that meet NOAA mission requirements;
Delivery of services and solutions with a streamlined
acquisition methodology; and,
Provides competitive solutions from a pool of exceptional
small and large businesses.
Obtain high quality professional and technical services
Task Areas –
1. Studies, Analyses and Reports
2. Applied Research and Consulting
3. Data Collection and Surveys
4. Program and Project Management
Develop an industrial base of partners
Develop and maintain performance-based contracts
Streamline/simplify procurement process by having
contracts in place.
Reduction in award time
Contribute to the overall NOAA mission

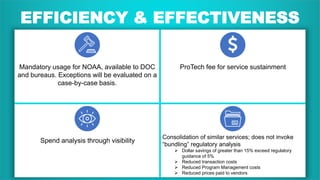

8. EFFICIENCY & EFFECTIVENESS
Mandatory usage for NOAA, available to DOC
and bureaus. Exceptions will be evaluated on a
case-by-case basis.
ProTech fee for service sustainment
Spend analysis through visibility
Consolidation of similar services; does not invoke
“bundling” regulatory analysis
Dollar savings of greater than 15% exceed regulatory
guidance of 5%
Reduced transaction costs
Reduced Program Management costs
Reduced prices paid to vendors
9. ROLES & RESPONSIBILITIES
Contracting
Officer (CO)
IDIQ Contract
Level
ProTech
Program
Management
Office (PMO)
ProTech
Program
Manager (PPM)
Contracting
Officer’s
Representative
(COR)
ProTech IDIQ
Contract
Level
Contracting
Officer
Task Order
Level
(TO CO)
NOAA AGO
Ombudsman
Prime
Contractor
Holders’
Program
Manager
10. ORDERING GOVERNED
BY FAR 16.505
Must provide each awardee a "fair opportunity to be
considered" for each order in excess of $3,500.
The fair opportunity process is not subject to protest –
with exceptions.
Performance-based acquisition methods must be used
to the maximum extent practicable.
Source selection procedures in FAR Subpart 15.3 do
not apply.
Simpler and more efficient process
Less costly and time-consuming for both the
NOAA and the contractors
11. PROTECH
OVERVIEW
GENERAL
CONTRACT
MANAGEMENT
TASK-ORDER –
ORDERING
PROCEDURES
QUESTIONS
Only firms awarded a contract under the relevant domain will be allowed fair opportunity to be
considered for task orders under that domain.
The Contracting Officer will determine relevant domain based on scope and client consultation
regardless of staff or Line affiliation. A task order requirement shall be created in one domain
only.
Each task order requirement will be evaluated and the Contracting Officer will determine if the
fair opportunity will be limited to socio-economic groups, small business firms under the
domain or open to all firms under the domain.
The Contracting Officer may use solicitation precursor techniques (requests for information,
source capability statements, pre-proposal conferences, oral presentations) to determine
whether the task order may be limited to small business firms or made available to all firms
within the domain.
1
2
3
4

12. ORDERING PROCEDURES
o Prime Contract Management
o Standardized Operating Procedures (SOPs)
o Review/Edit SOW/PWS/SOO packages
o Review request package to establish an RFP
o Coordinate COR technical review of proposals
o Prepare proposal packages for COR/source
selection review Award
o Validate funds to support requirements
o Award Task Order
o Establish Task Order Kick-Off Meeting
o Establish post award log
o Provide 90-120 day reminders for
options/follow-ons, as needed
o Evaluate Contractor’s performance via Contractor
Performance Assessment Reporting System
(CPARS)
o Conduct contract management functions for all
mods (i.e., Can include, POP extensions,
additional scope of work, reduced scope of work,
adjustment of funds, administrative)
3%
feeFee includes access to the ProTech suite of
contracts, to include the following ancillary
services as required:
13. ORDERING PROCEDURES
o The ProTech fee will be recovered through the
regular PR obligation process in C.Suite.
o Clients shall ensure that the appropriate
ProTech object class code (26-03) appears in
the PR line of accounting
o The system will automatically calculate and
attribute the fee to the proper account at
obligation.
o The amount on the resulting PR will not reflect
the fee, so make sure your accounts contain
sufficient funds. Lack of funds will halt TO
award.
3%
feeFee includes access to the ProTech suite of
contracts, to include the following ancillary
services as required:

15. TRADITIONAL ORDER PROCESSING
1. SOO/SOW/PWS is sent with a “Request for Traditional Technical and
Cost/Price Proposal” to all contract holders within the designated Domain.
The request should typically place a limit of no more than fifteen 15 pages
on the technical proposal, subject to adjustment at the discretion of the TO
CO based on the size, scope and complexity of the TO. The request may
also include an oral presentation requirement if it is determined to be
beneficial to the evaluation. A complete cost or price proposal must be
submitted, with no page restrictions. The amount of time allowed for the
traditional response is typically eight days, which may be adjusted based
on the scope/complexity of the requirement and the needs of the program
office.
2. Technical and cost/price evaluations are conducted by the Government
evaluation teams designated according to the written Evaluation Plan.
3. Exchanges take place (if needed).
4. A TO is awarded to the successful offeror.
16. MULTIPHASE FAIR OPPORTUNITY PROCESSING
1. A SOO/SOW/PWS is sent with a request for a multiphase proposal to all prime contractors
within the designated Domain IDIQ portfolio. The request could be for a written proposal,
oral proposal, or both. If the Phase 1 request includes a written proposal, the request would
typically place a limit of no more than seven pages for the response, which encompasses
the proposed technical and management approach, as well as past performance
information. Within the seven pages, the offeror should also include a preliminary estimate
or not-to-exceed (NTE) estimate for cost. The amount of time allowed for the Phase 1
response is typically five days, which may be adjusted based on the scope/complexity of the
requirement and the needs of the customer. The request may also include an oral
presentation requirement if it is determined to be beneficial to the evaluation.
2. Technical evaluations and evaluations of the preliminary cost estimate/NTE are conducted
by the Government evaluation teams designated according to the written Evaluation Plan.
3. Based on the evaluations, a down-select could occur which identifies the contract holders
that would be most qualified to compete for the TO. The down-select process could identify
one or more prime contractors that are the most qualified.
4. Only the most qualified offeror(s) remaining after the down- select process will be invited to
submit a Phase 2 Traditional Technical and Cost/Price Proposal.
5. Technical and cost/price evaluations are conducted by the Government evaluation teams
designated according to the Evaluation Plan.
6. Exchanges would take place (if needed).
17. 1. Request For Task Order Proposal
Development
3. Issuance Of The Request For Task
Order Proposals
5. Task Order Award
2. Task Order Solicitation Preparation
4. Evaluation
6. Notification To Unsuccessful Offeror(s)
PROTECH HIGH-LEVEL CONTRACT PROCEDURES
18. REQUEST FOR TASK ORDER
PROPOSAL DEVELOPMENT
At a minimum the Program Office will provide:
o Appropriate Work Statement(s) (SOO/SOW/PWS)
o Performance location of the work
o Period of performance/deliverable schedule
o Applicable performance standards
o Any special regulations, including applicable Section 508 requirements
or exceptions
o An Independent Government Cost Estimate (IGCE)
o Contractor evaluation criteria and evaluation plan
o Funded purchase request (PR) – must cite ProTech object code “26-03”
19. TASK ORDER SOLICITATION PREPARATION
TO CO
o Reviews the Request
o Determines the application of any Fair Opportunity Exception,
including SB Set-Aside
o Determine the task order proposal request process approach
• Traditional Process
• Multiphase Process
o Prepares a Task Order Solicitation

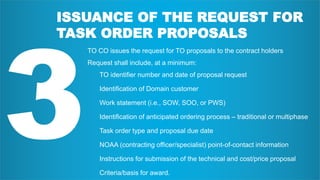

20. ISSUANCE OF THE REQUEST FOR
TASK ORDER PROPOSALS
TO CO issues the request for TO proposals to the contract holders
Request shall include, at a minimum:
TO identifier number and date of proposal request
Identification of Domain customer
Work statement (i.e., SOW, SOO, or PWS)
Identification of anticipated ordering process – traditional or multiphase
Task order type and proposal due date
NOAA (contracting officer/specialist) point-of-contact information
Instructions for submission of the technical and cost/price proposal
Criteria/basis for award.
21. EVALUATION
The TO CO receives the offers in accordance with the request for offers.
Technical and cost/price evaluations are conducted by the Government
technical evaluation team designated according to the written evaluation plan
as required.
The TO CO will lead in any exchanges for the Government side, if needed.
The TO CO, in coordination with the TO COR, shall prepare a completed
award recommendation package
22. TASK ORDER AWARD
The TO CO awards the task order
A copy of the award and any subsequent modifications shall be forwarded to
ProTech@noaa.gov.

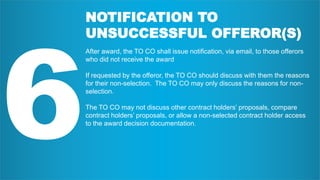

23. NOTIFICATION TO
UNSUCCESSFUL OFFEROR(S)
After award, the TO CO shall issue notification, via email, to those offerors
who did not receive the award
If requested by the offeror, the TO CO should discuss with them the reasons
for their non-selection. The TO CO may only discuss the reasons for non-
selection.
The TO CO may not discuss other contract holders’ proposals, compare
contract holders’ proposals, or allow a non-selected contract holder access
to the award decision documentation.
