Project estimates using Monte Carlo simulation
Speaker introduction: Stefano Martincigh
Project estimates using Monte Carlo simulation
More details: https://www.linkedin.com/in/stefano-martincigh-90ba2132/
Impress them!
Establish
credibility...
Our environment
Project estimates using Monte Carlo simulation
Our environment
Project estimates using Monte Carlo simulation
Planning:
Project estimates using Monte Carlo simulation
Planning:
Project estimates using Monte Carlo simulation
What can we do?
Project estimates using Monte Carlo simulation

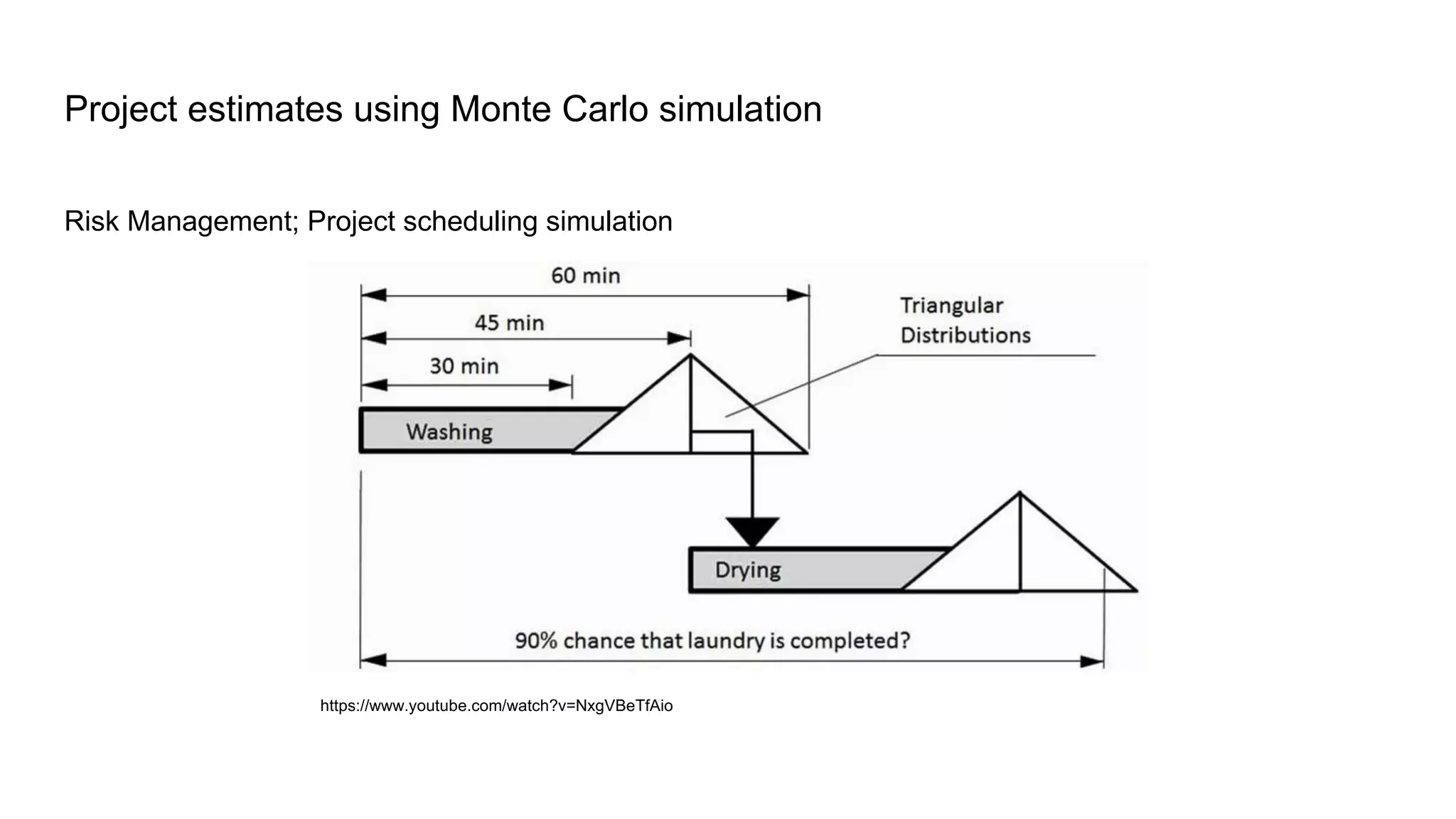

Risk Management; Project scheduling simulation
Project estimates using Monte Carlo simulation
https://www.youtube.com/watch?v=NxgVBeTfAio

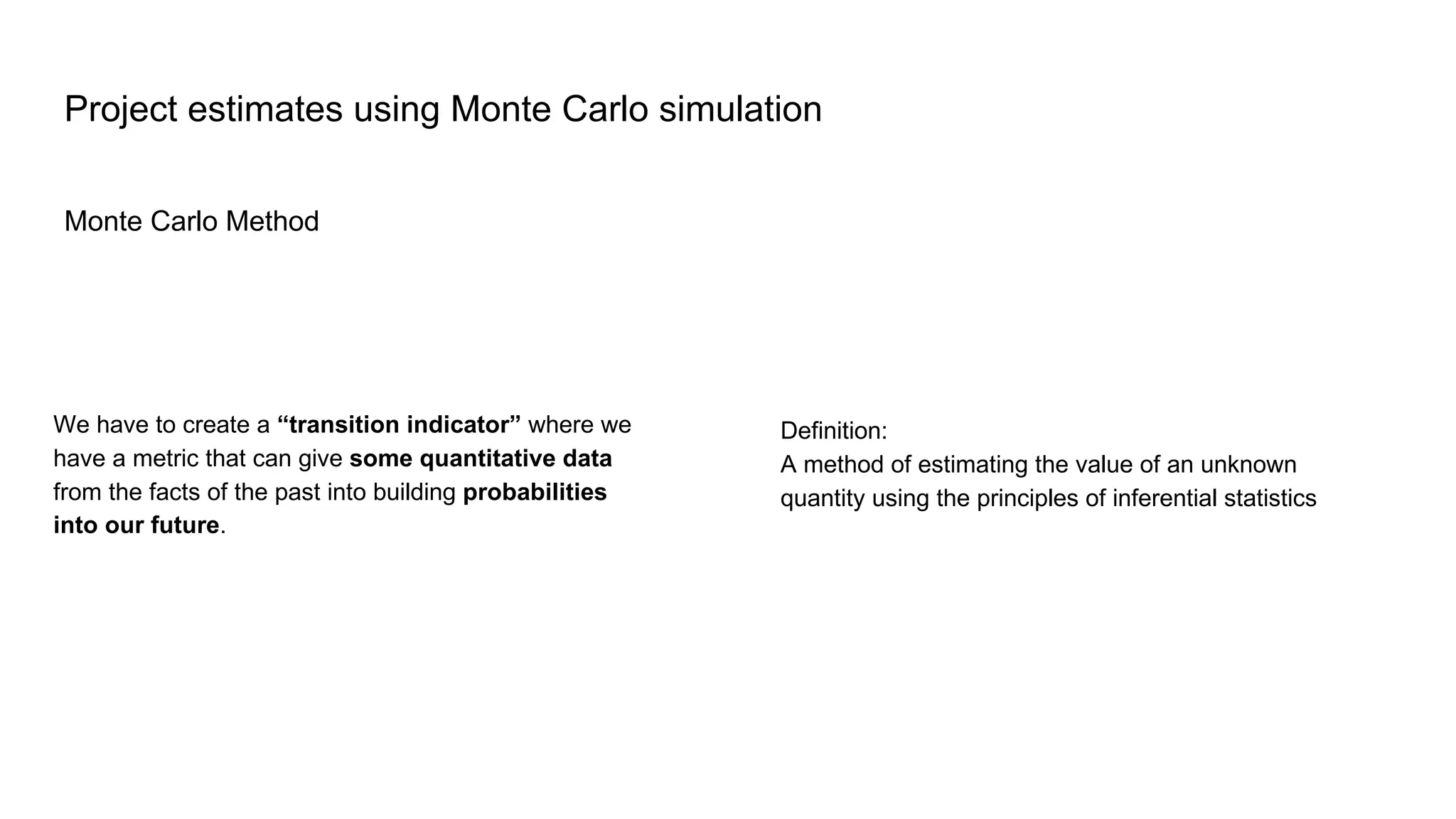

Monte Carlo Method
Project estimates using Monte Carlo simulation
Definition:
A method of estimating the value of an unknown
quantity using the principles of inferential statistics
We have to create a “transition indicator” where we
have a metric that can give some quantitative data
from the facts of the past into building probabilities
into our future.
Monte Carlo Method steps:

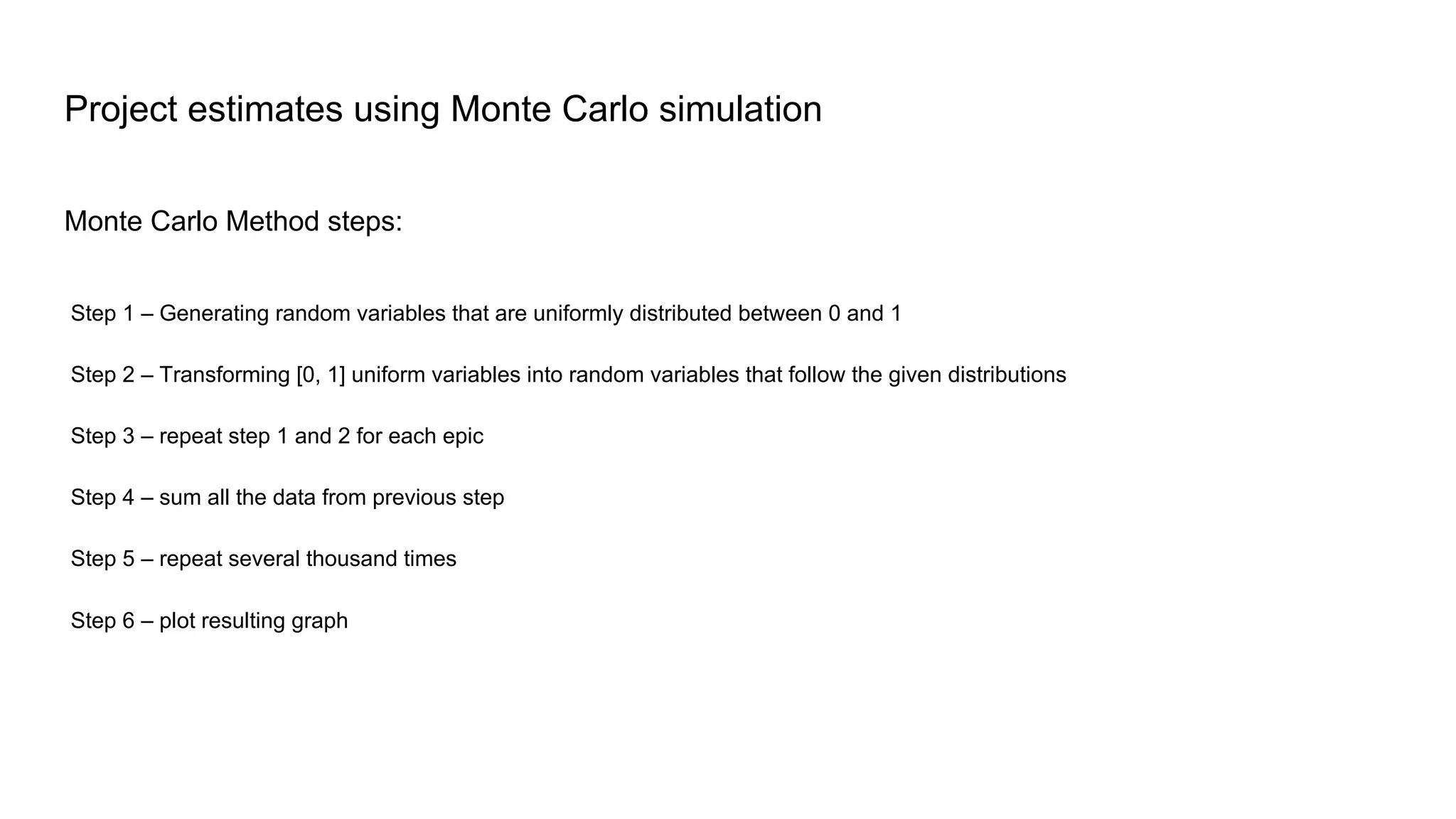

Project estimates using Monte Carlo simulation
Step 1 – Generating random variables that are uniformly distributed between 0 and 1
Step 2 – Transforming [0, 1] uniform variables into random variables that follow the given distributions
Step 3 – repeat step 1 and 2 for each epic
Step 4 – sum all the data from previous step
Step 5 – repeat several thousand times
Step 6 – plot resulting graph
Epics definition

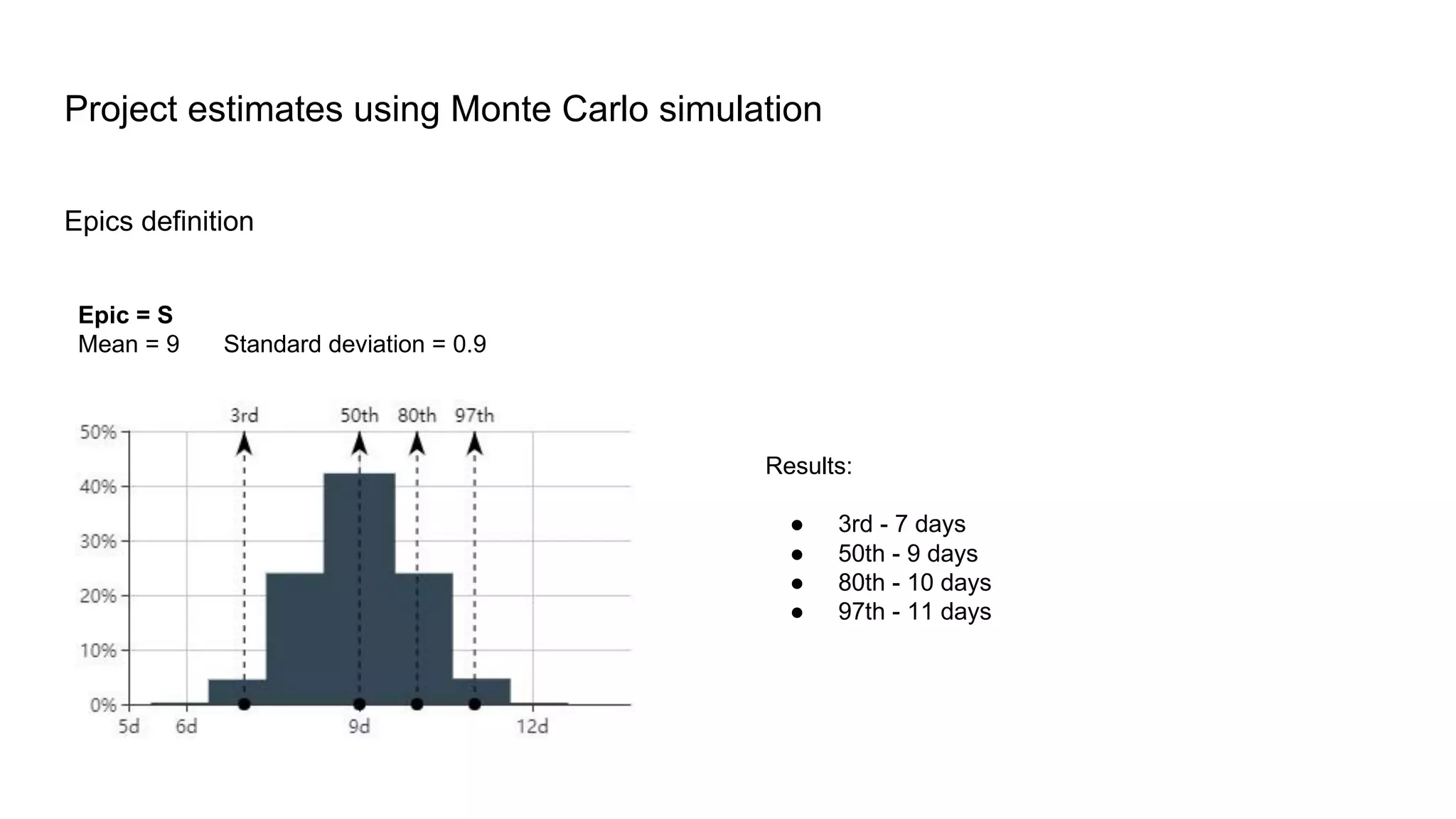

Project estimates using Monte Carlo simulation
Epic = S
Mean = 9 Standard deviation = 0.9
Results:
● 3rd - 7 days
● 50th - 9 days
● 80th - 10 days
● 97th - 11 days
Epics definition

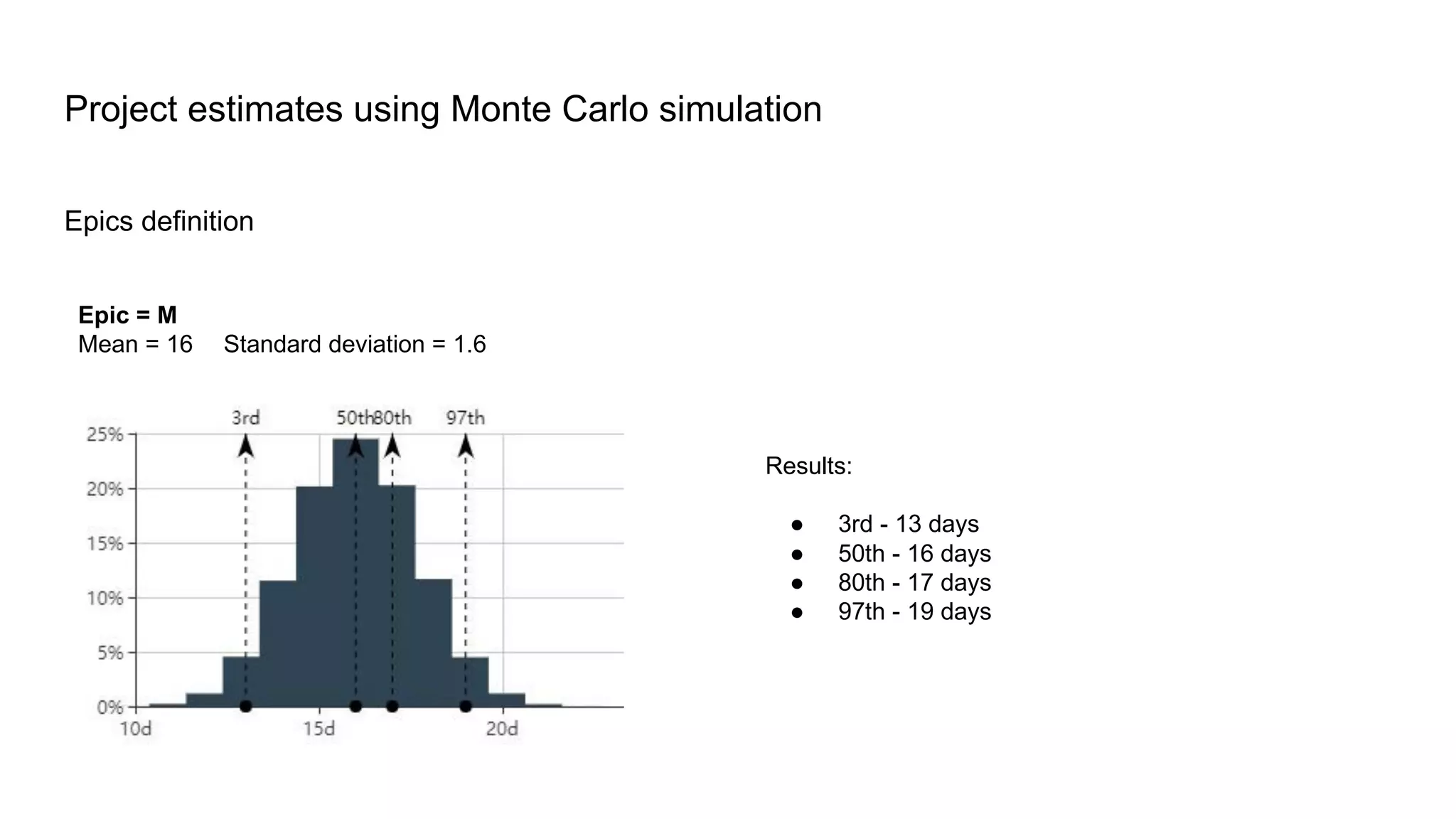

Project estimates using Monte Carlo simulation
Epic = M
Mean = 16 Standard deviation = 1.6
Results:
● 3rd - 13 days
● 50th - 16 days
● 80th - 17 days
● 97th - 19 days

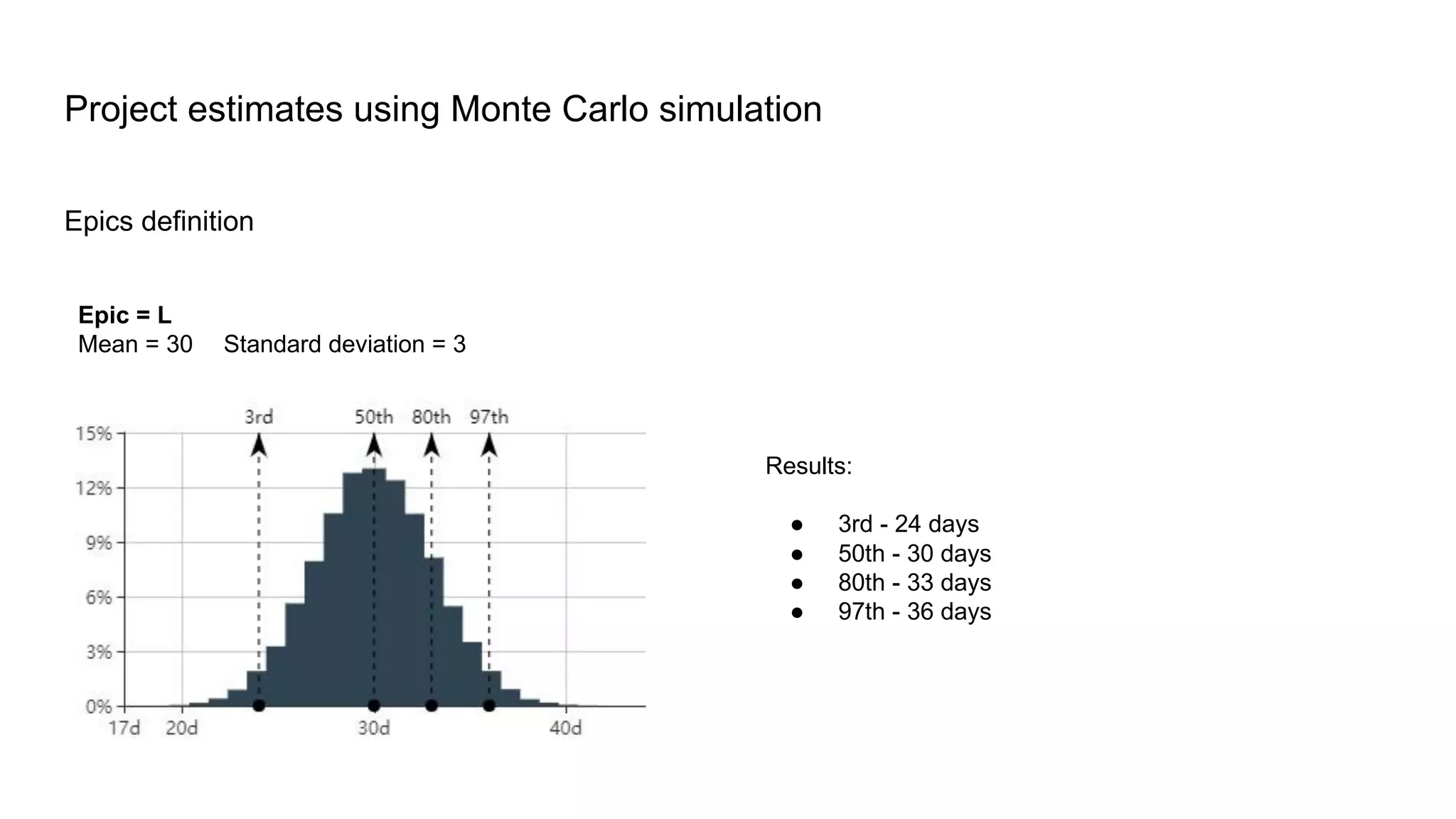

Epics definition
Project estimates using Monte Carlo simulation
Epic = L
Mean = 30 Standard deviation = 3
Results:
● 3rd - 24 days
● 50th - 30 days
● 80th - 33 days
● 97th - 36 days
Project example

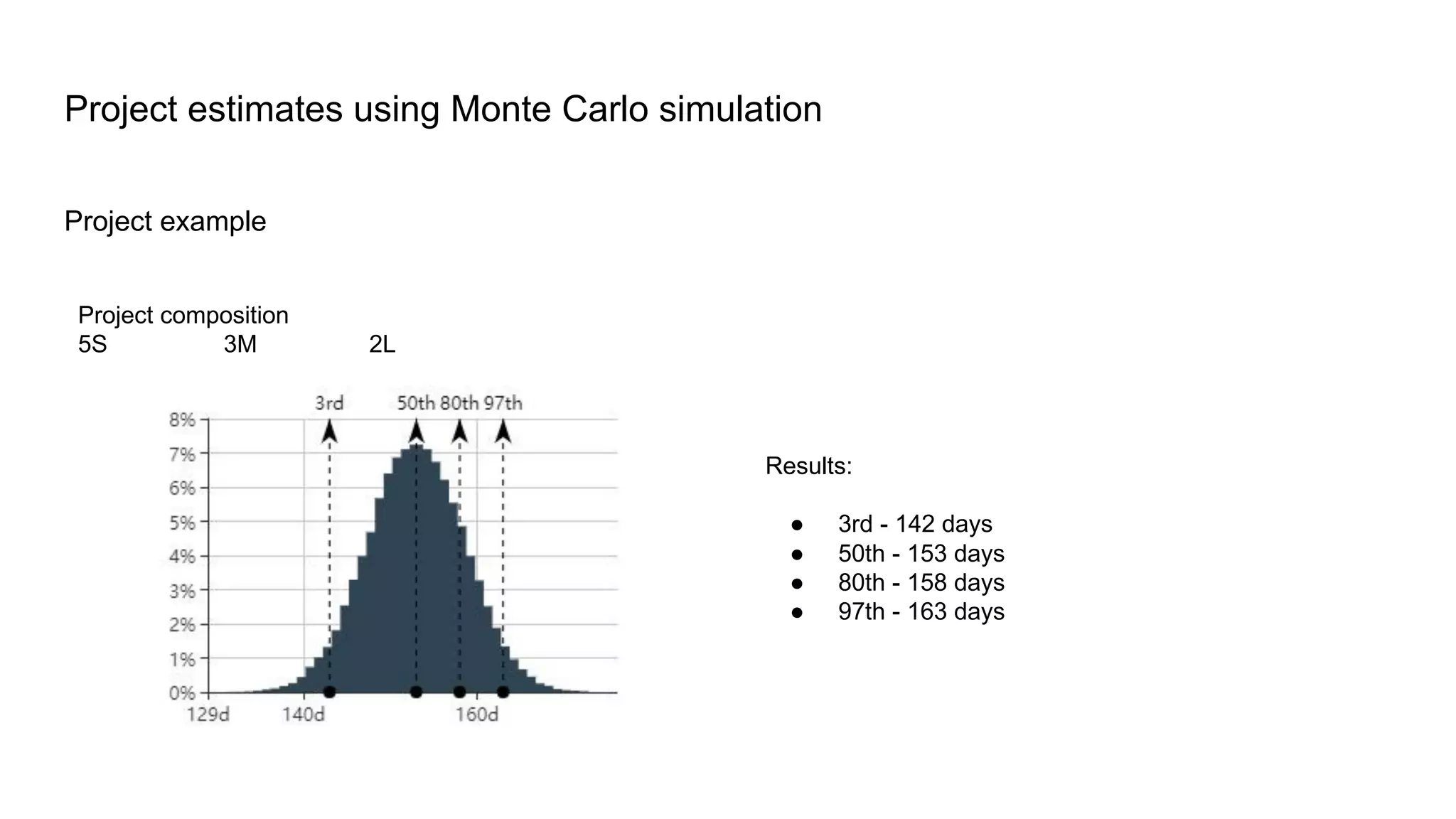

Project estimates using Monte Carlo simulation
Project composition
5S 3M 2L
Results:
● 3rd - 142 days
● 50th - 153 days
● 80th - 158 days
● 97th - 163 days
Discussion time!
Project estimates using Monte Carlo simulation
Able to influence Graphs observations
Deeper analysis
Project estimates using Monte Carlo simulation
The Pert distribution: 4 parameters - Min, Max, Mode, Height
Deeper analysis

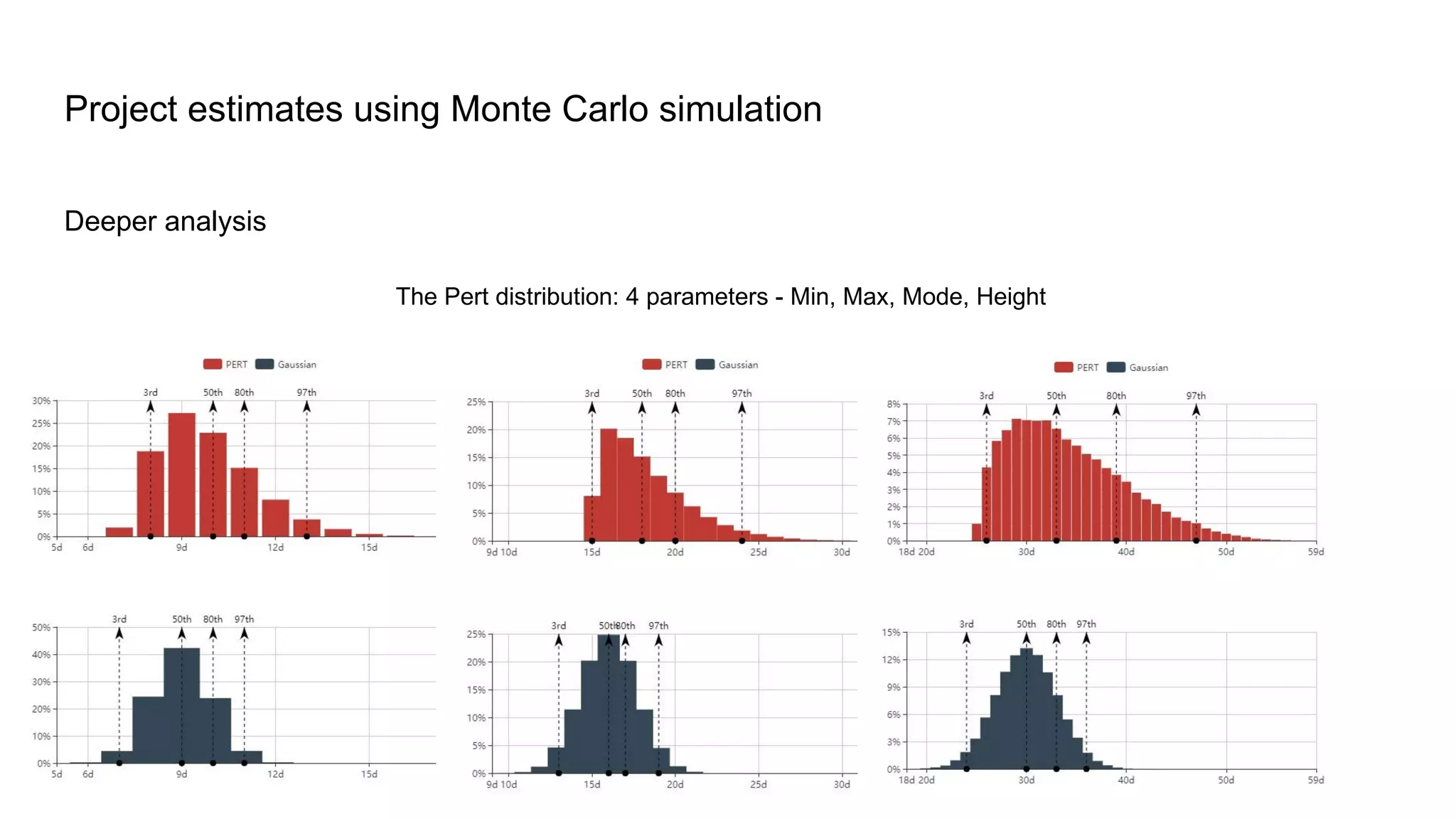

Project estimates using Monte Carlo simulation
The Pert distribution: 4 parameters - Min, Max, Mode, Height

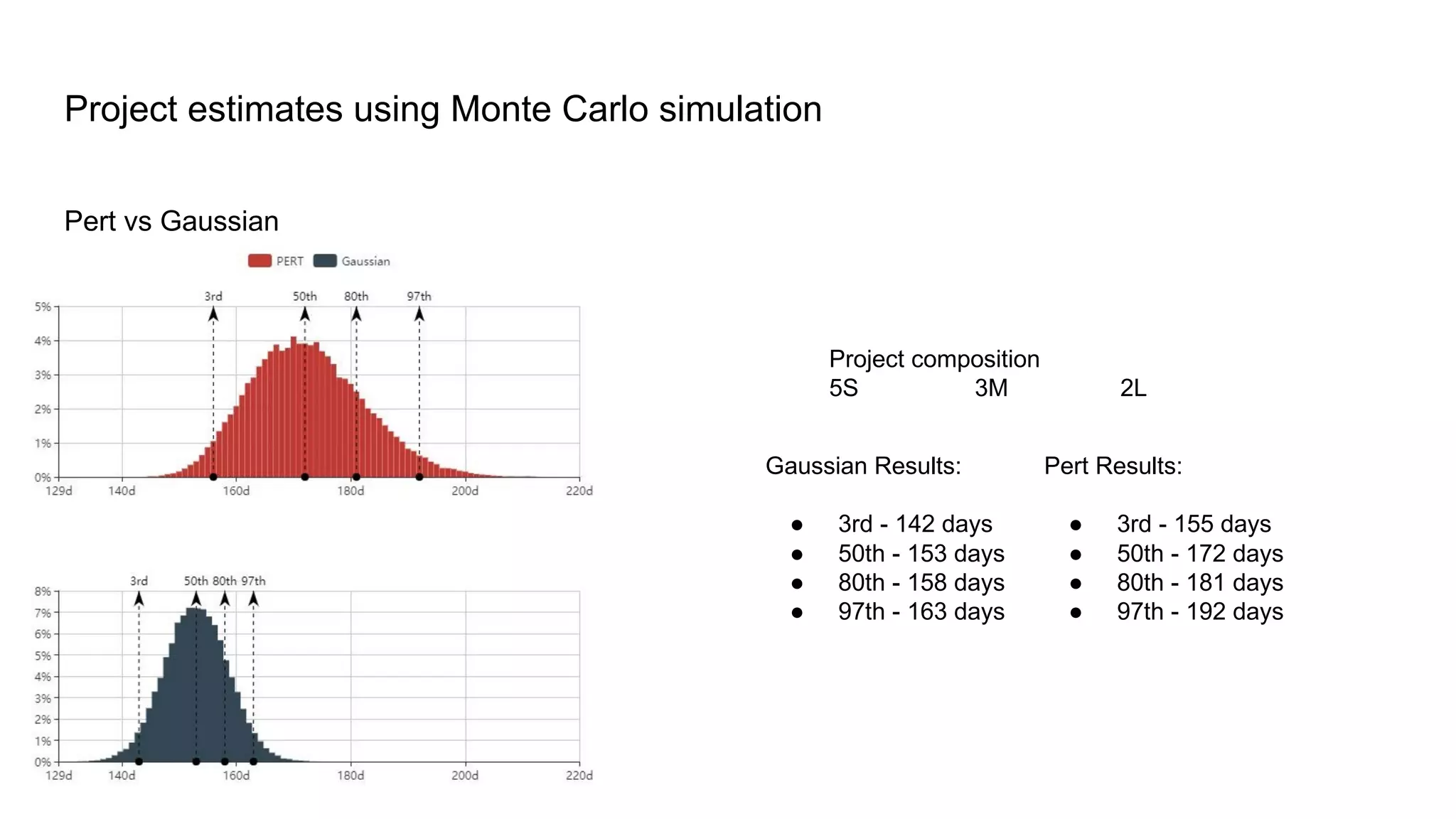

Pert vs Gaussian
Project estimates using Monte Carlo simulation
Project composition
5S 3M 2L
Gaussian Results:
● 3rd - 142 days
● 50th - 153 days
● 80th - 158 days
● 97th - 163 days
Pert Results:
● 3rd - 155 days
● 50th - 172 days
● 80th - 181 days
● 97th - 192 days
Factors which negatively impact this analysis
Project estimates using Monte Carlo simulation

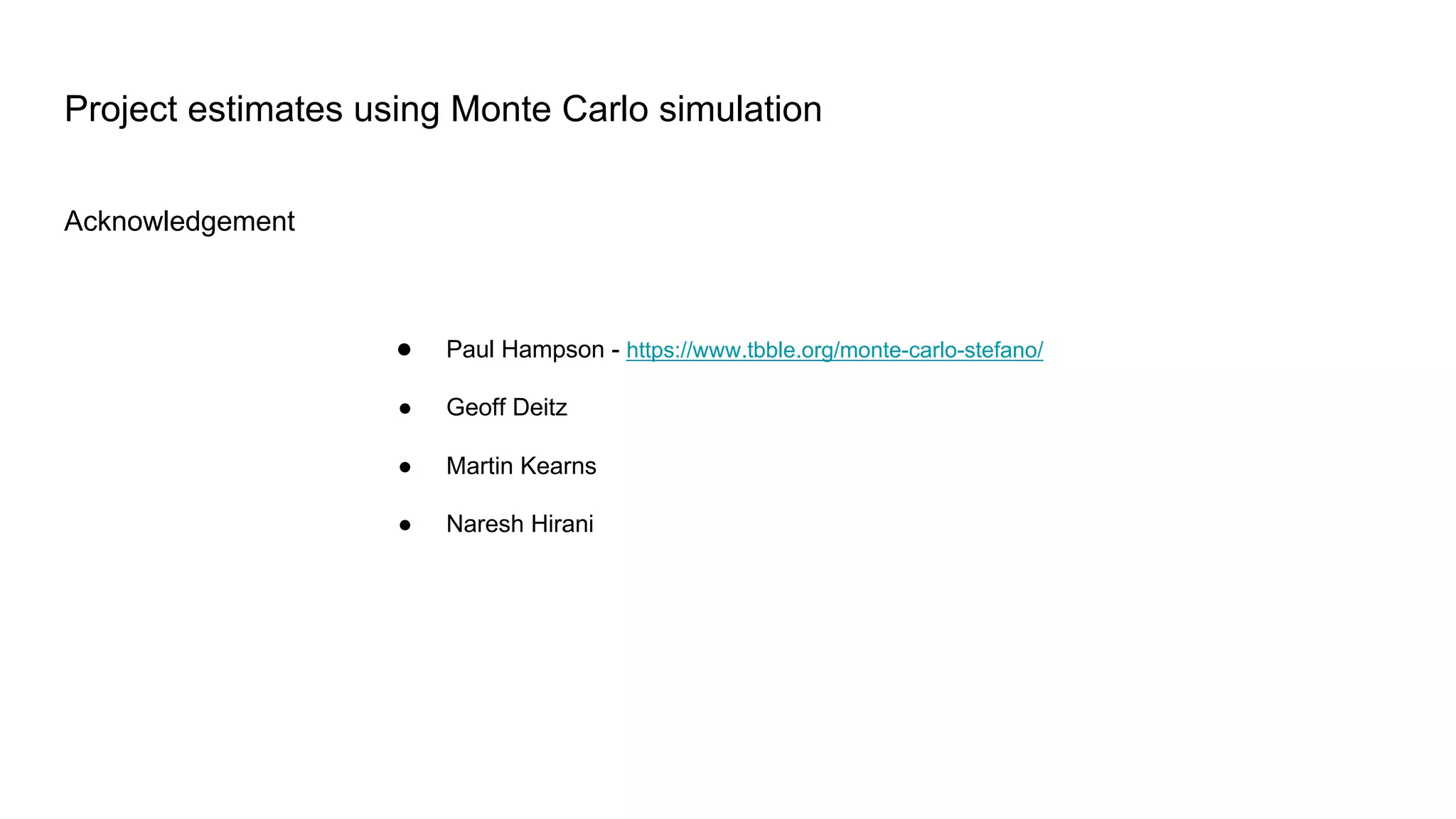

Acknowledgement

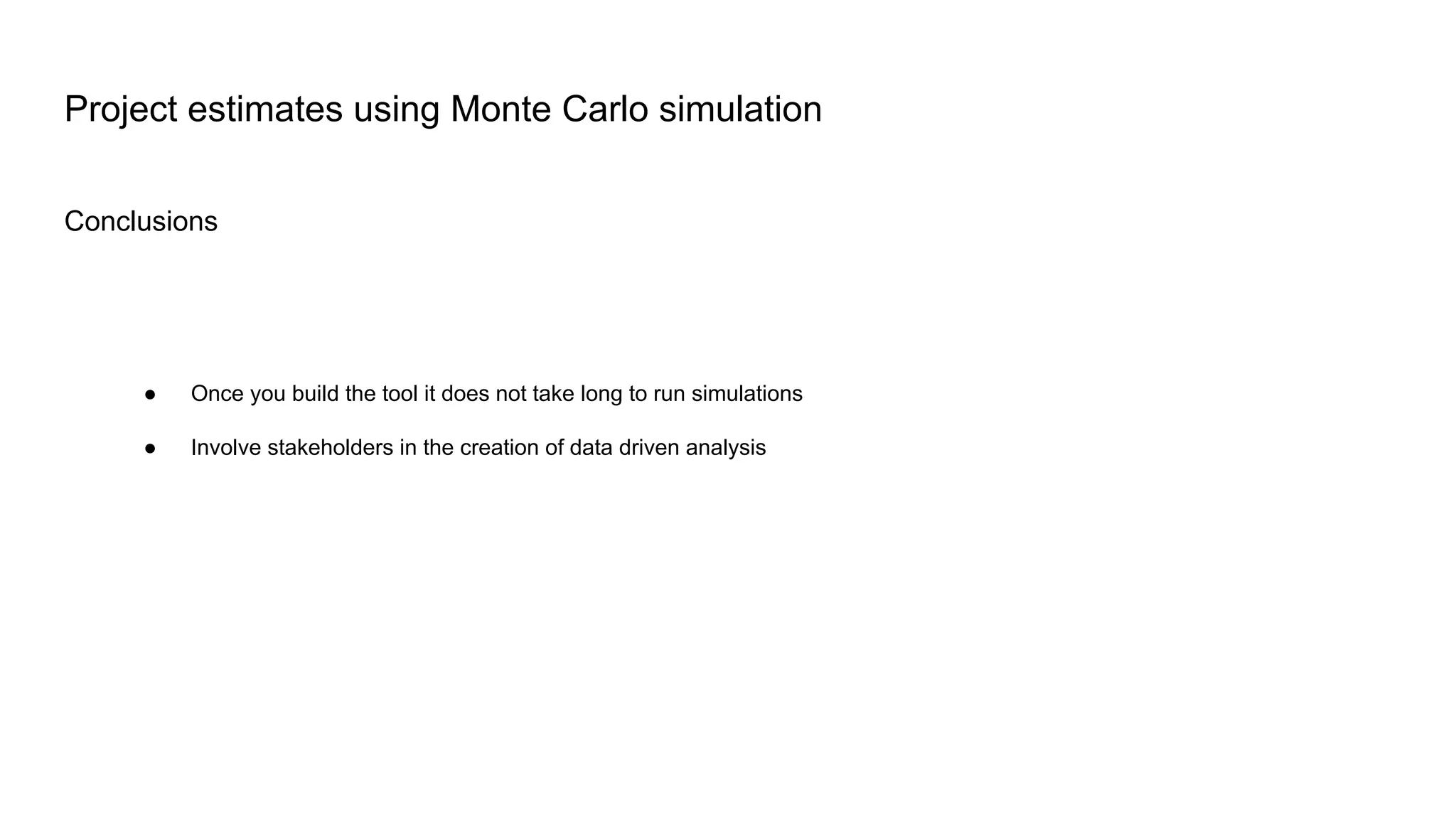

Project estimates using Monte Carlo simulation
● Paul Hampson - https://www.tbble.org/monte-carlo-stefano/
● Geoff Deitz
● Martin Kearns
● Naresh Hirani
Conclusions
Project estimates using Monte Carlo simulation
● Once you build the tool it does not take long to run simulations
● Involve stakeholders in the creation of data driven analysis
Conclusions
Project estimates using Monte Carlo simulation
● Once you build the tool it does not take long to run simulations
● Involve stakeholders in the creation of data driven analysis
Project estimates using Monte Carlo simulation
