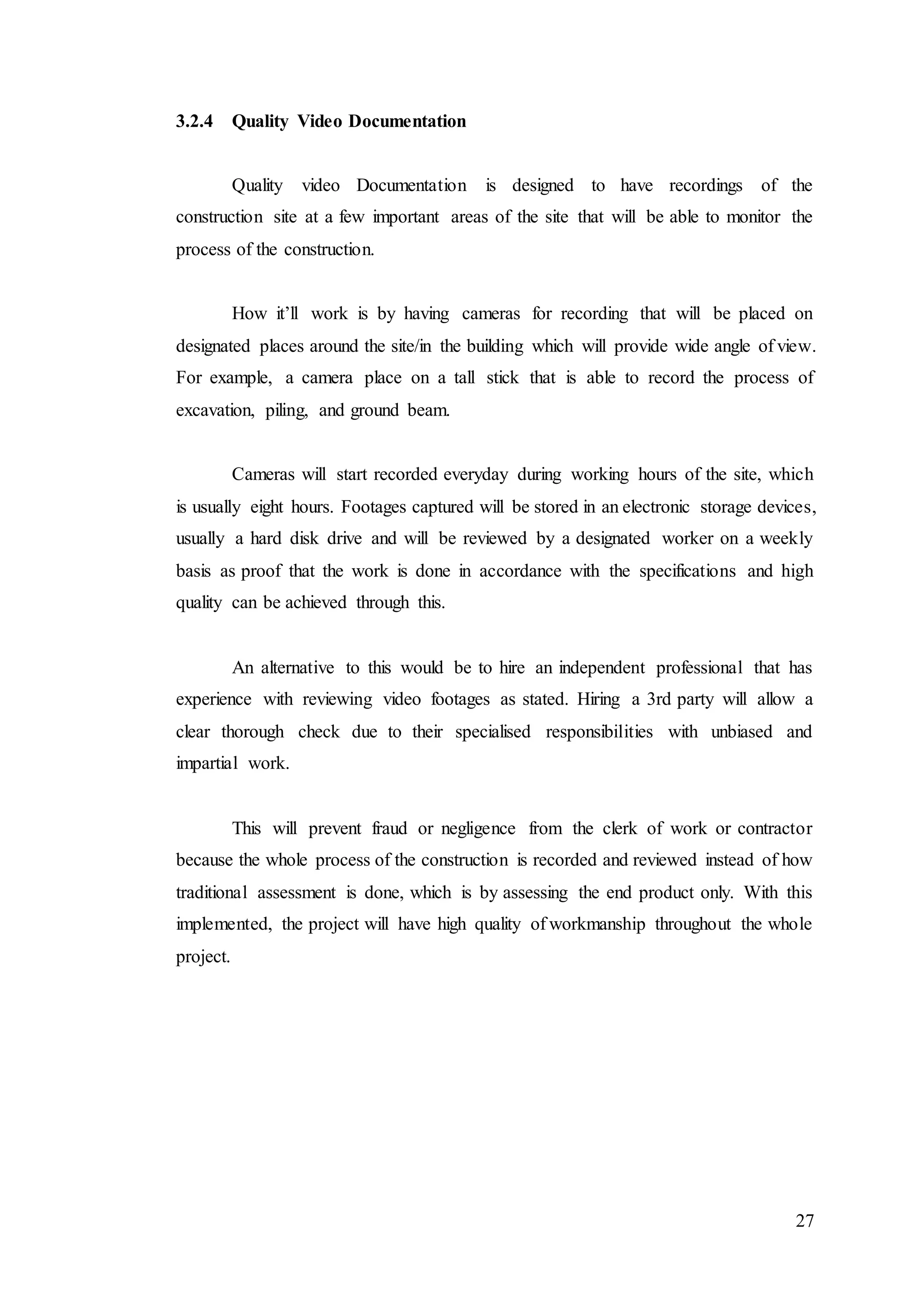

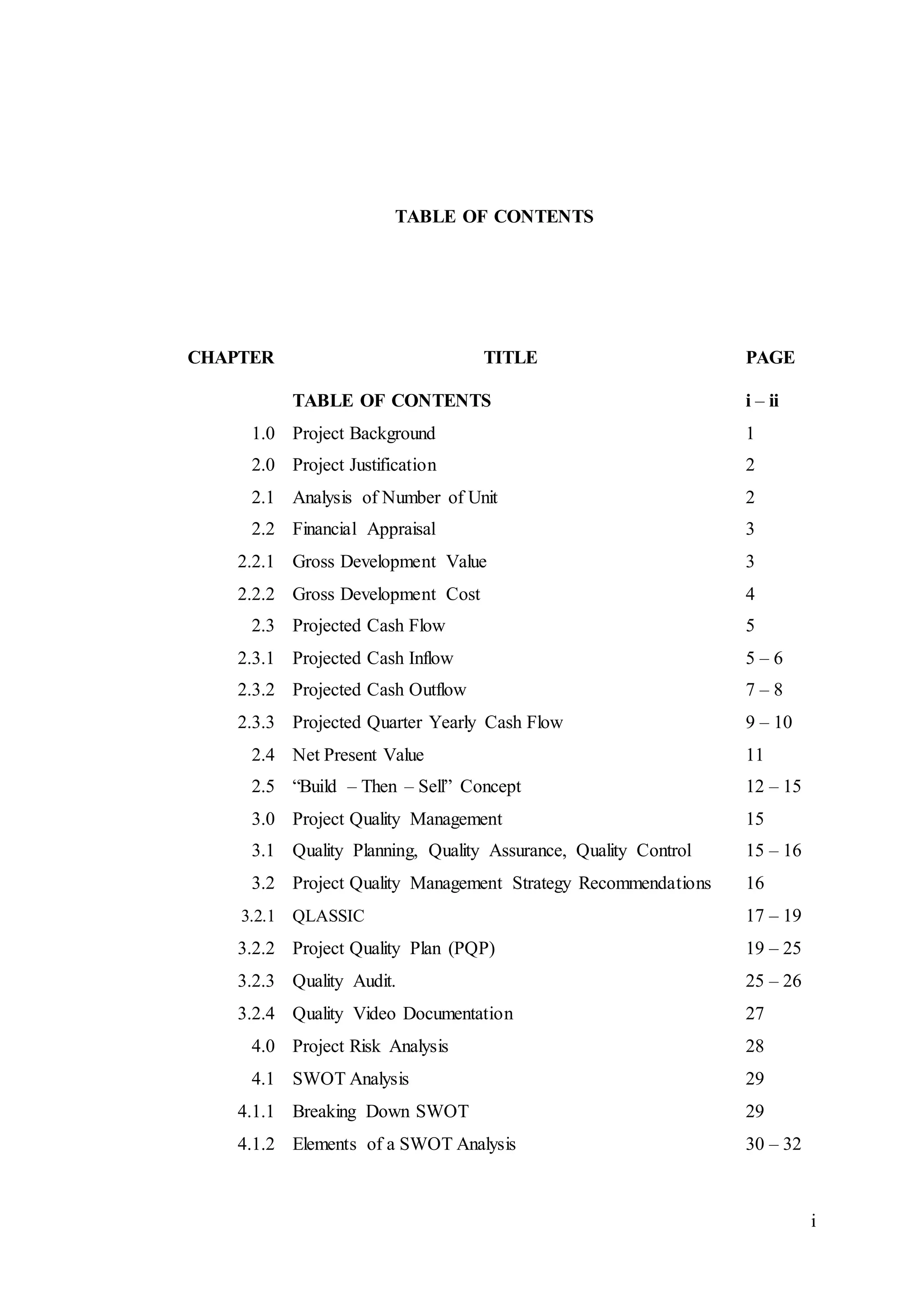

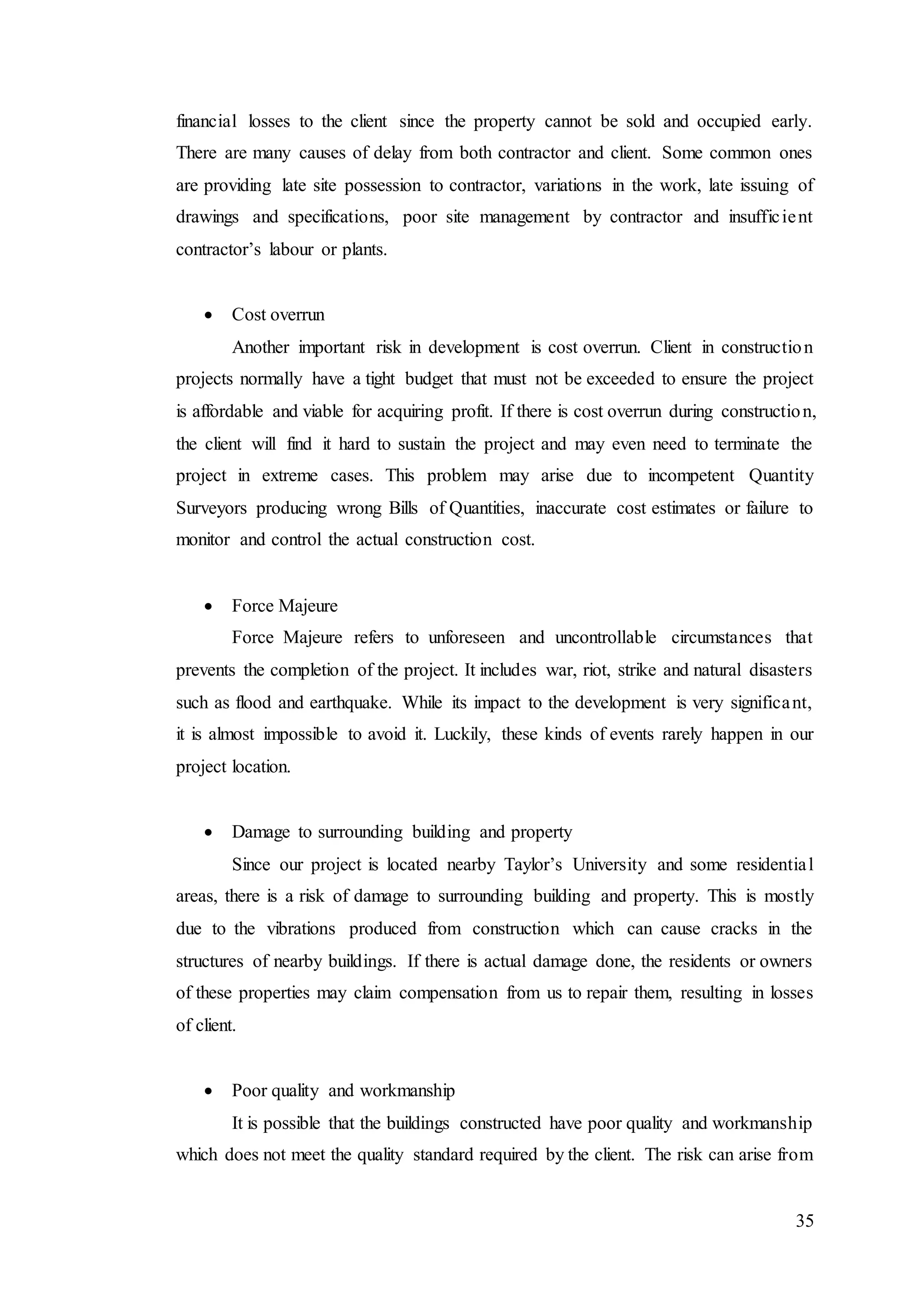

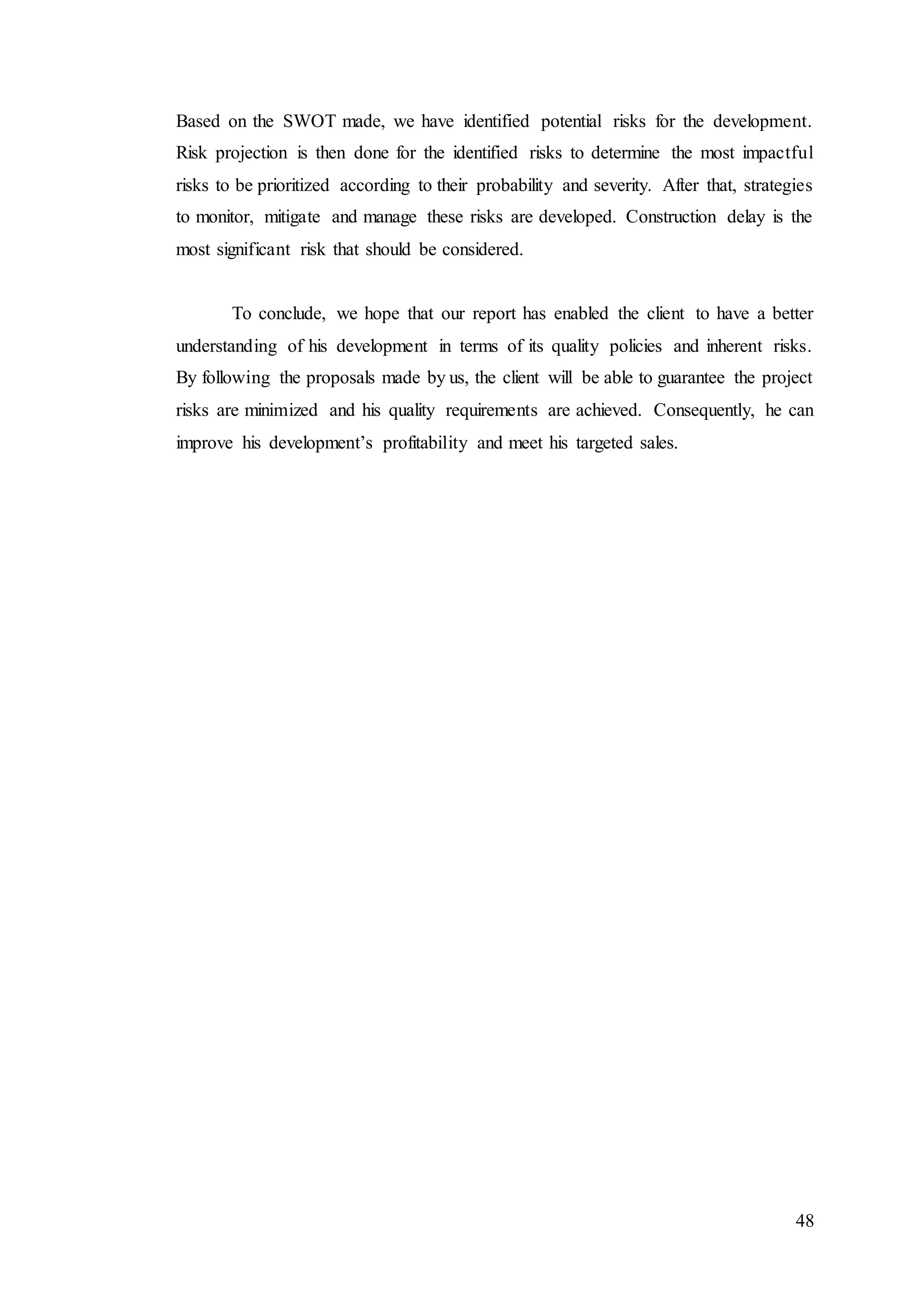

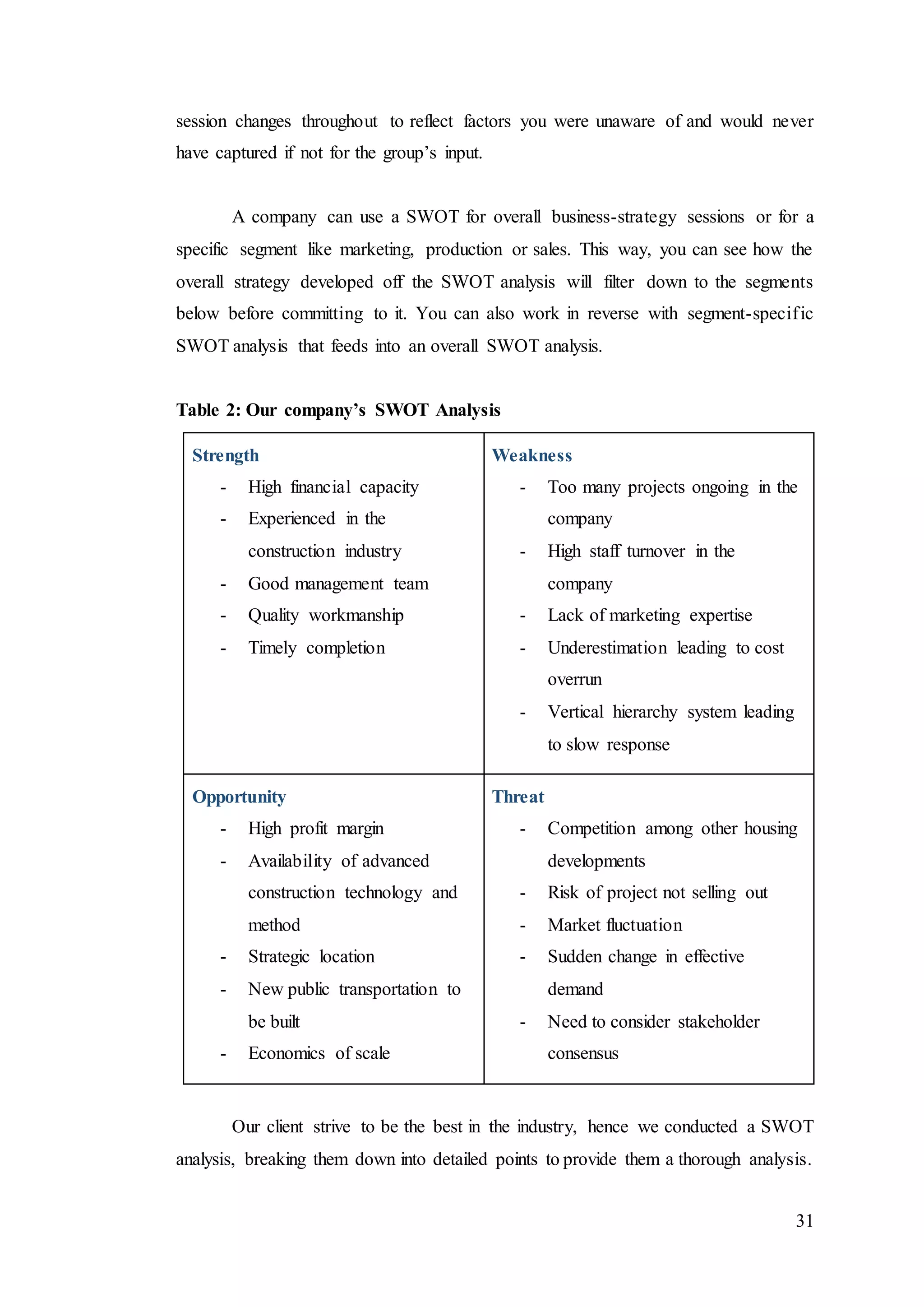

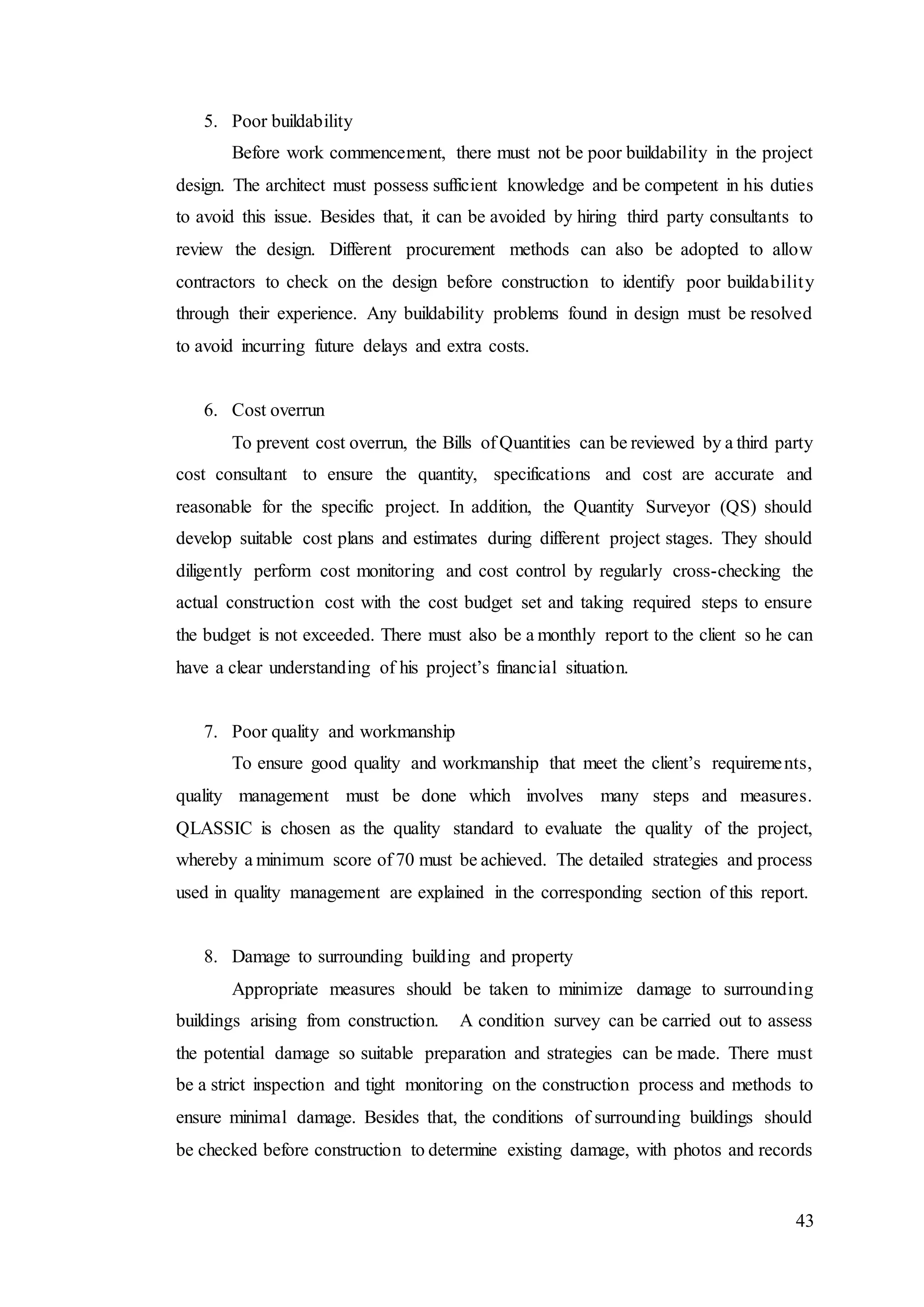

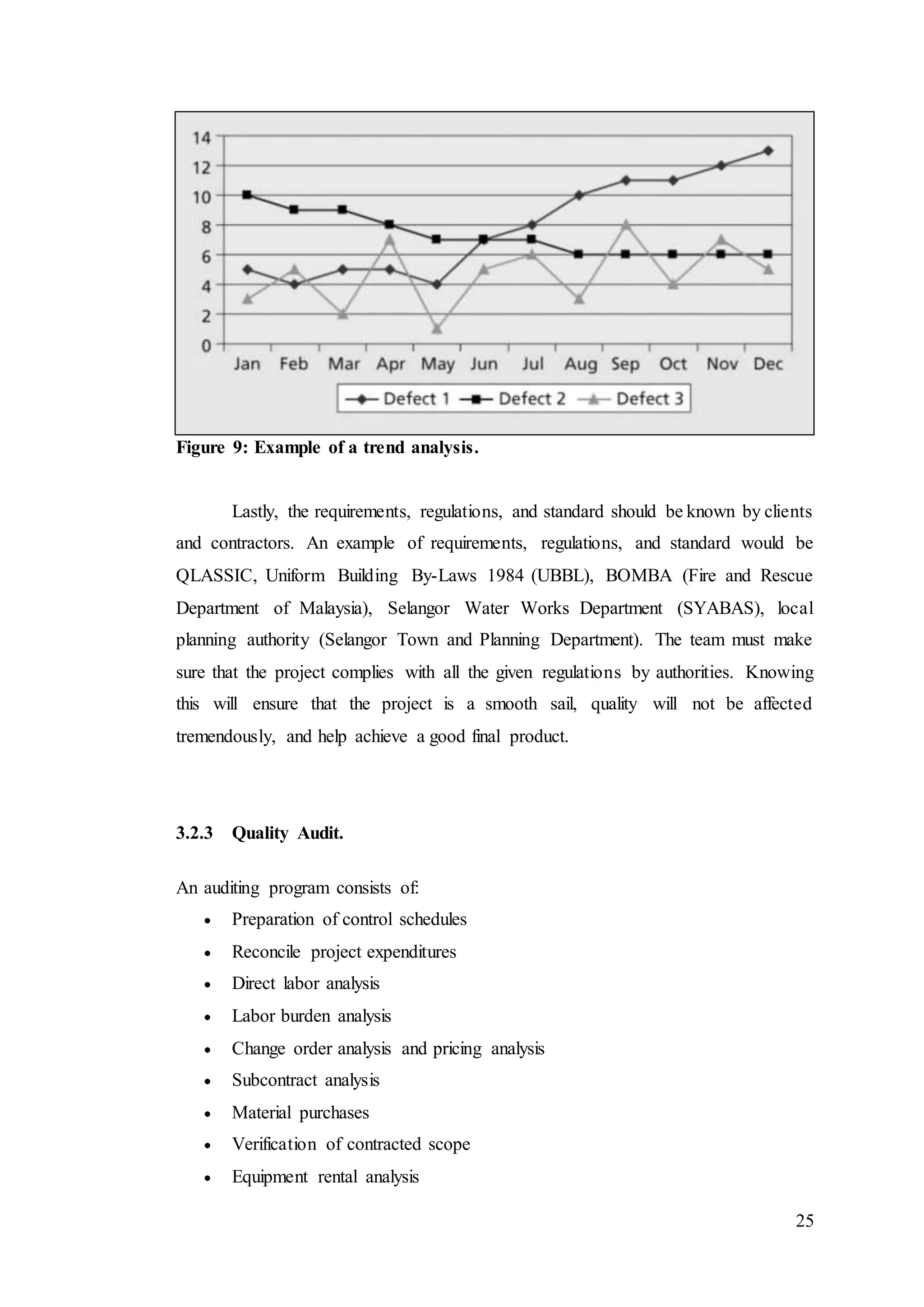

The document summarizes a group project to develop a piece of freehold land beside Taylor's University in Selangor, Malaysia. It includes a background on the project site and proposed development, which will consist of double story shop lots, terrace houses, and low cost homes. The document also covers project justification through financial analysis and cash flow projections. It recommends strategies for quality management, including implementing QLASSIC standards, developing a Project Quality Plan covering roles and responsibilities, and conducting regular inspections, documentation, and testing to ensure work meets specifications.
This document provides a quality management plan for a project to open a new salon called Rejuvenate. The plan outlines the project's objectives to provide high-quality beauty services and products at affordable prices. It describes the project scope, deliverables, timeline and milestones. The quality processes that will be implemented include planning and defining quality standards, undertaking quality assurance activities, and controlling quality. Total quality management principles will be used to ensure customer satisfaction and continuous improvement. Key roles in quality management include the project manager, quality control manager, and sponsor.
This document provides a quality management plan for a project to open a salon called Rejuvenate. It outlines the project's objectives to provide high-quality salon services to customers and expand the business. The quality management plan defines the quality standards, organizational roles, and quality assurance and control processes that will be implemented. The plan is intended to help ensure all project deliverables and activities meet requirements for safety, customer satisfaction, and business growth.
Project Management Group Assignment Final ReportArissa Loh
This document provides details of a group assignment for a Bachelor of Quantity Surveying course. It outlines the proposed development of a mixed-use project located next to Taylor's University consisting of a supermarket, retail shops, and car park. The document includes sections on project background, proposed design, time management, cost estimation, quality management, risk management, and procurement management. Work breakdown structures and a critical path method are utilized to plan the project schedule. Cost estimates are provided for construction, development, operations, and potential profits over 20 years. Quality and risk management strategies are also recommended.
BSBH Construction Sdn. Bhd. is a construction company located in Petaling Jaya, Malaysia with RM1 million in capital. The company was founded in March 2017 and aims to provide best construction services to gain customer trust through exceptional performance. The document outlines the company's vision, short, mid and long term goals, organizational structure including different departments and roles, and value statement. It provides details on the project, engineer, and safety departments and roles of site engineers, quantity surveyors, supervisors, and structural engineers.
The document provides details of a proposed games and recreational center project in Kuala Lumpur, Malaysia. It includes sections on the project introduction and objectives, site analysis, project viability, design suitability, and project procurement. The key points are:
- The project aims to build a new games and recreational center to replace an existing sports complex and promote active living.
- A site analysis identifies strengths such as proximity to parks and schools, and weaknesses like limited site accessibility.
- The project goals are to create a sustainable environment and establish an active living identity for the site.
- Design considerations include layout, key features like a rock climbing wall, and ensuring programs are visually connected.
The document outlines the design development process for the Taylor's Recreation Station project. It includes sections on architectural, interior, landscape, civil and structural, mechanical and electrical designs. It also includes project management aspects such as the work breakdown structure, table of dependencies, PERT chart and Gantt chart which outline the project timeline and dependencies between tasks from schematic design to final completion.
project management, documenting architect This involves the documentation of your Studio Vl Architectural Design Project, to apply the principles learned in
Assignment 1 to your final project. Students from Design Studio lV or V will use their design in Studio lV or V for
the study Your task is to document your own Design Studio Project from the point of view of an Architect, commissioned to
undertake this project.
This document provides details of a value management study conducted for a mixed development project in Port Dickson, Negeri Sembilan, Malaysia. It includes an introduction to value management, an executive summary of the project, and outcomes from the value management workshop. The workshop proposed several approaches to increase value for the client through minor adjustments to increase usable area and change parking orientation, while selecting alternative materials and roof types to reduce costs. Sketches and financial analyses were provided to support the recommendations.
This document provides a quality management plan for a project to open a new salon called Rejuvenate. The plan outlines the project's objectives to provide high-quality beauty services and products at affordable prices. It describes the project scope, deliverables, timeline and milestones. The quality processes that will be implemented include planning and defining quality standards, undertaking quality assurance activities, and controlling quality. Total quality management principles will be used to ensure customer satisfaction and continuous improvement. Key roles in quality management include the project manager, quality control manager, and sponsor.
This document provides a quality management plan for a project to open a salon called Rejuvenate. It outlines the project's objectives to provide high-quality salon services to customers and expand the business. The quality management plan defines the quality standards, organizational roles, and quality assurance and control processes that will be implemented. The plan is intended to help ensure all project deliverables and activities meet requirements for safety, customer satisfaction, and business growth.
Project Management Group Assignment Final ReportArissa Loh

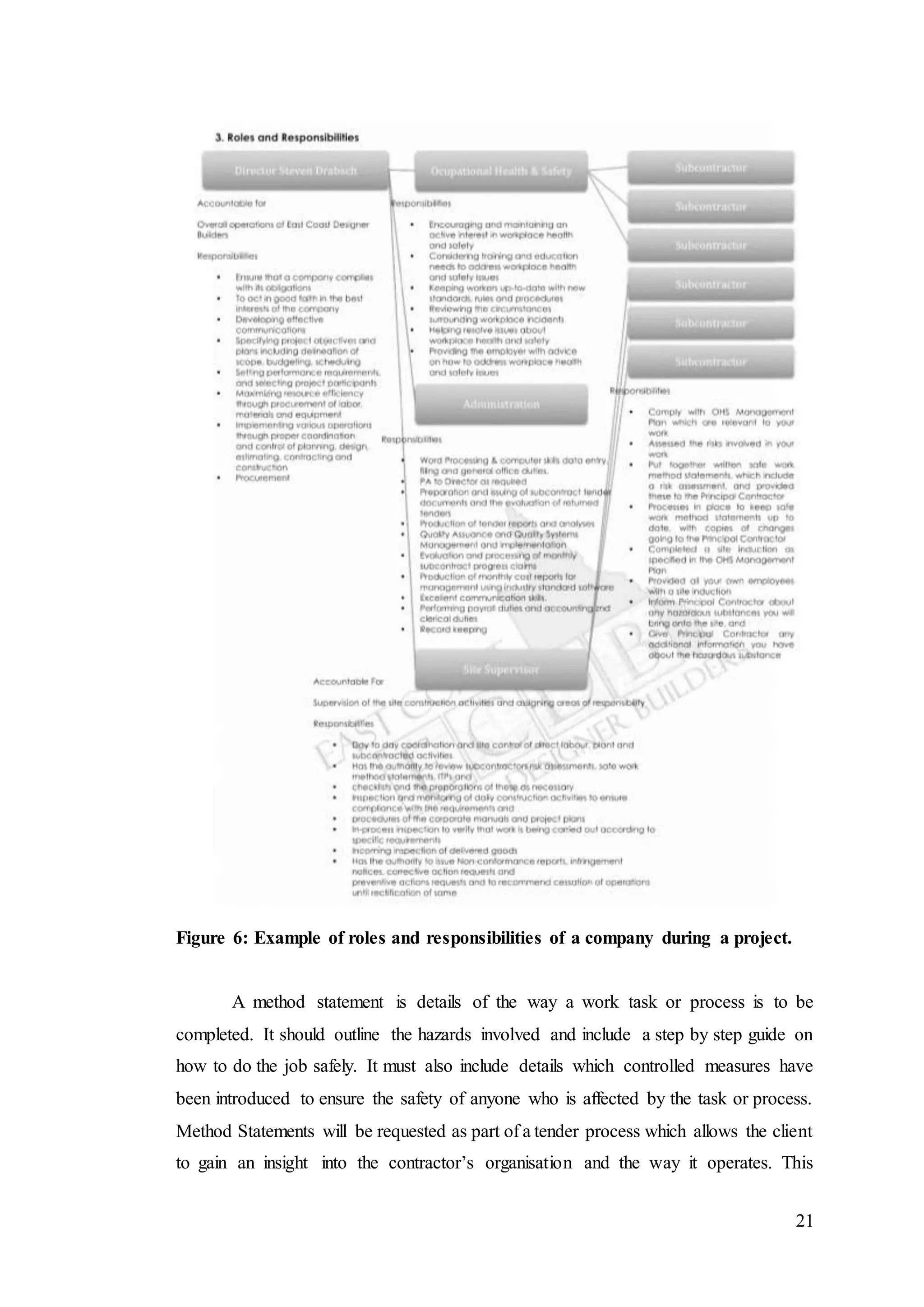

This document provides details of a group assignment for a Bachelor of Quantity Surveying course. It outlines the proposed development of a mixed-use project located next to Taylor's University consisting of a supermarket, retail shops, and car park. The document includes sections on project background, proposed design, time management, cost estimation, quality management, risk management, and procurement management. Work breakdown structures and a critical path method are utilized to plan the project schedule. Cost estimates are provided for construction, development, operations, and potential profits over 20 years. Quality and risk management strategies are also recommended.
BSBH Construction Sdn. Bhd. is a construction company located in Petaling Jaya, Malaysia with RM1 million in capital. The company was founded in March 2017 and aims to provide best construction services to gain customer trust through exceptional performance. The document outlines the company's vision, short, mid and long term goals, organizational structure including different departments and roles, and value statement. It provides details on the project, engineer, and safety departments and roles of site engineers, quantity surveyors, supervisors, and structural engineers.
The document provides details of a proposed games and recreational center project in Kuala Lumpur, Malaysia. It includes sections on the project introduction and objectives, site analysis, project viability, design suitability, and project procurement. The key points are:
- The project aims to build a new games and recreational center to replace an existing sports complex and promote active living.
- A site analysis identifies strengths such as proximity to parks and schools, and weaknesses like limited site accessibility.
- The project goals are to create a sustainable environment and establish an active living identity for the site.
- Design considerations include layout, key features like a rock climbing wall, and ensuring programs are visually connected.
The document outlines the design development process for the Taylor's Recreation Station project. It includes sections on architectural, interior, landscape, civil and structural, mechanical and electrical designs. It also includes project management aspects such as the work breakdown structure, table of dependencies, PERT chart and Gantt chart which outline the project timeline and dependencies between tasks from schematic design to final completion.
project management, documenting architect This involves the documentation of your Studio Vl Architectural Design Project, to apply the principles learned in

Assignment 1 to your final project. Students from Design Studio lV or V will use their design in Studio lV or V for
the study Your task is to document your own Design Studio Project from the point of view of an Architect, commissioned to
undertake this project.
This document provides details of a value management study conducted for a mixed development project in Port Dickson, Negeri Sembilan, Malaysia. It includes an introduction to value management, an executive summary of the project, and outcomes from the value management workshop. The workshop proposed several approaches to increase value for the client through minor adjustments to increase usable area and change parking orientation, while selecting alternative materials and roof types to reduce costs. Sketches and financial analyses were provided to support the recommendations.
This document provides information about a Project Management course offered at the School of Management Studies. It includes details like the course code, title, type, presenter, semester, and academic year. The course objectives are outlined, which are to equip students with project management knowledge and skills. The syllabus is divided into four units covering topics like project planning, scheduling, cost estimation, procurement, and project closure. Reference books and online resources are also listed.
1. Response needed for the below postBased on the sophisticated .docxjeremylockett77

The document discusses cyber security strategies and approaches. It argues that security approaches need to diversify and broaden in scope given modern threats like cloud computing, IoT, and connected devices. Machine learning, data mining, and predictive capabilities will be important for future-proofing security strategies. Conclusions about making security more proactive and dynamic are superficial without specificity about different fields. The document also discusses a quality management plan for a suburban home construction project, outlining quality standards, objectives, roles, processes, and control activities.

Project Quality management in Project ManagementMITSDEDistance
The PGDM Project Management course at MITSDE aligns with the Project Management Institute's curriculum, offering comprehensive training by experienced professionals.
IRJET- Construction Quality Management on SiteIRJET Journal
This document discusses quality management in the construction industry. It begins by defining quality in construction as meeting or exceeding client requirements. It then discusses the importance of quality control and quality assurance in construction projects to ensure projects are completed on time, on budget, and to a high standard. The document reviews literature on total quality management in construction and identifies key factors like top management commitment, customer focus, and quality planning. It also outlines some quality management techniques used in construction like independent inspections, quality audits, and a quality magazine. Finally, it describes the research methodology used, which involves surveying experienced quality engineers and contractors about quality management practices through questionnaires.
This Presentation create a basic information and Idea about the Project Management Practices. The data was compiled from the reputed sources for better understanding.
The CTA implemented an ISO 9001 quality management system and ProjectNet, a web-based project management system, to improve efficiency in managing its multi-billion dollar capital improvement program. The systems were designed to streamline processes, focus on customer satisfaction, and enable continuous quality improvement. After implementing the systems over 12 months, the CTA received ISO 9001 certification. ProjectNet and the quality system provided benefits like reduced project durations, improved collaboration, and cost savings. Examples showed projects being completed ahead of schedule and under budget. The quality initiatives improved the CTA's capital program management and delivered benefits to citizens through more efficient transportation improvements.
This Power Point Presentation is useful for Project coordinators ,Project Engineers,Project Developers,Project Managers in Construction field,Construction Managements,Construction Management review,contract and construction overview

The Major Projects Delivery team at Auckland Council was established in 2006 to deliver large capital projects across the council. It operates using a matrix structure with project managers overseeing workstreams led by subject matter experts. This structure provides consistency across projects and allows the team to leverage expertise from other parts of the council. The team has delivered nearly $1 billion in projects over the past decade, transforming communities. They use a process mapping tool called Pro-Mapp to document standardized processes for project delivery.

The Major Projects Delivery team at Auckland Council was established in 2006 to deliver large capital projects across the council. Since then, the team has delivered nearly $1 billion worth of projects, transforming communities. They have a matrix structure with project managers, workstream experts, and corporate workstream owners to ensure consistency. Notable projects include the Aotea Square redevelopment, Auckland Art Gallery upgrades, and Te Wao Nui at Auckland Zoo. The team has received numerous national and international awards for project quality and innovation.
For decades, persistent failure has marred the delivery of capital investment projects in the resource development sector. Regrettably even though the causes are well known, companies have been slow to respond with effective control strategies. As the scale and complexity of projects has increased so too has the magnitude of shareholder value destruction. It seems that when the biggest projects fail, they fail spectacularly. Performance statistics going back several decades demonstrate that mining projects of all sizes and complexity mostly fail to achieve objectives. For a time, the commodities super cycle, which peaked in 2011, concealed poor capital expenditure discipline. High sales prices cover many sins, but recent price turbulence has exposed companies to a legacy of record impairments and over-priced and under-performing assets unprecedented in the modern era. This has led to a renewed focus on reducing or eliminating capital expenditure. Companies spending on capital developments have an opportunity to apply new levels of discipline to both the allocation and delivery of capital in an environment of stagnating labour costs and increasing competitiveness. Contracting approaches that provide greater opportunities for cost certainty or gross cost reduction are now more readily available as contractors are prepared to accept greater levels of cost and schedule risk to secure work. Mining companies must also improve in-house project management capability, especially in risk management and performance control. Teams of proven performers should be equipped with sound management processes and tools to capture the value of the opportunity at the front-end of the project delivery cycle and maintain that value through to completion. We conclude with an overview of our proprietary capital delivery process and management system to demonstrate a methodology that reduces risks in a project portfolio and greatly increases the likelihood of achieving predictable project outcomes.

Project Management Course & Tutorial by eAcademy.lkUdara Sandaruwan
