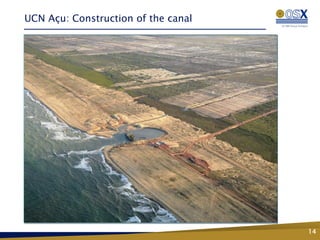

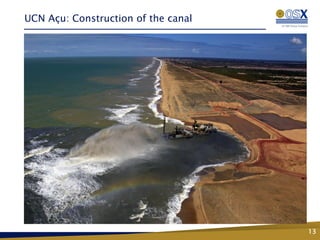

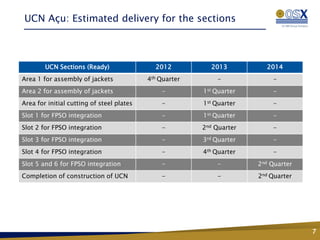

This document provides a project update for November 2011 on several OSX shipbuilding initiatives. Key details include:

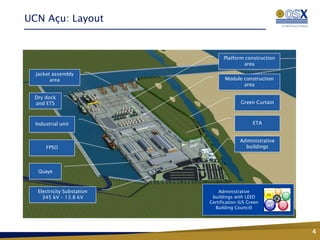

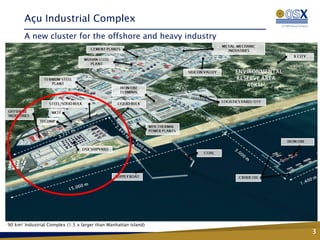

- Construction is underway at the 90km2 Açu Industrial Complex in Brazil, with licensing obtained and construction of various areas and infrastructure progressing.

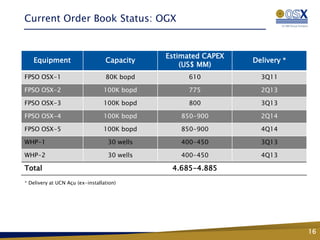

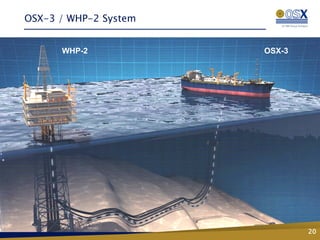

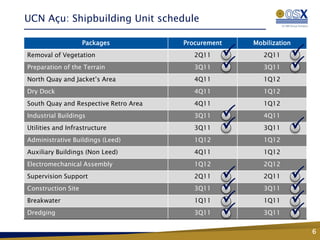

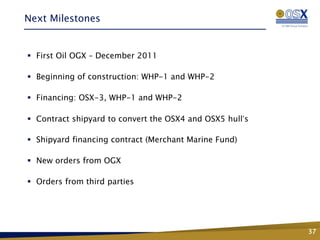

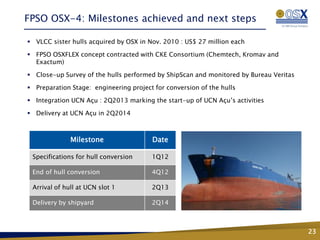

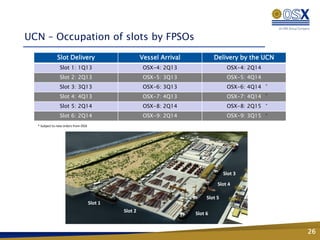

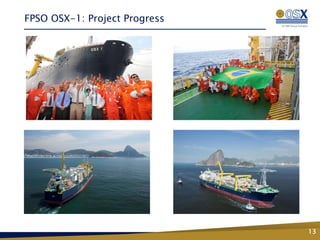

- The order book includes FPSOs OSX-1 through OSX-5 along with WHP-1 and WHP-2, with delivery timelines ranging from late 2011 through 2014.

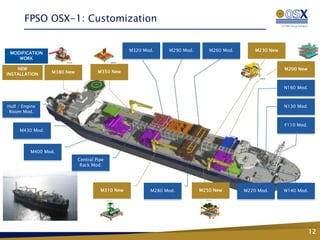

- Progress is outlined on the individual FPSO and WHP units, including customization work, integration timelines at the Açu facility, and financing arrangements.

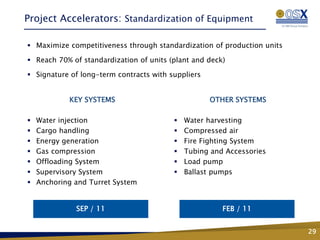

- Plans are discussed to accelerate future projects through standardization, engineering innovations
