March 09 – August 2009
Saipem UK
Lead Engineer: -
Frigg 2009 Decommissioning
Campaign
Removal of the Quarters Platform (QP)
- Pre and post transit survey of the route
into the Aker stored facility. Dredging of
the pile locations, diamond wire cutting of
the piles and one piece removal of the
jacket by the S7000 .

Removal of the Drilling Platform 1
(DP1)
Use of subsea remote intervention
technology. Pre-dredging at level one,
“piece small” subsea preparation,
dismantling, lifting and transfer of jacket
sections to subsea storage containers.
General seabed debris removal.
11 weeks offshore operations
May 08 -
CTC Marine Projects Limited
Senior Project Manager: -
BP Shefa II Project

120km lay & burial of Fibre Optic product
running from the BP Clair Platform
through to the BP Schiehallion FPSO in
the north east Atlantic, approximately
140km NNE of Cape Wrath, west of
Shetland Islands. Workscope included,
Subsea Clamp installation, dynamic riser
pull-in and hang off assembly. Product
tensioning at the Clair Platform. FOTA
deployment at Schiehallion FPSO.
Eleven crossings to bridge. Recovery and
splicing of BU tails at the FT FO cable
intersection. Trenching of the product
utilises the CTC T1 Wheel Cutting
Tractor & ISU 150te Plough. Construction
vessel Maersk Advancer. Project Value
£6.5million.

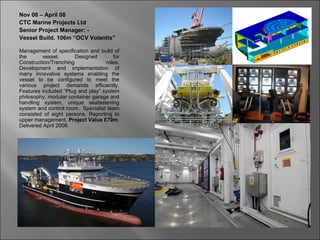

Nov 06 – April 08
CTC Marine Projects Ltd
Senior Project Manager: -
Vessel Build. 106m “OCV Volantis”

Management of specification and build of
the      vessel.       Designed       for
Construction/Trenching             roles.
Development and implementation of
many innovative systems enabling the
vessel to be configured to meet the
various project demands efficiently.
Features included “Plug and play” system
philosophy, modular container garage and
handling system, unique seafastening
system and control room. Specialist team
consisted of eight persons. Reporting to
upper management. Project Value £70m.
Delivered April 2008.
Nov 06 – April 08
CTC Marine Projects Ltd
Senior Project Manager: -
2000Te Carousel Lay System

Specification and management of lay
system including 17m Carousel, Fleeting
tower, Accumulator and Tensioner. A
modular designed system capable of
operation on multiple construction
vessels     in   various    configurations.
Included vessel hull analysis, grillage
design, analysis and build. Incorporated a
unique sea fastening system allowing
efficient    mob/demob.      Lay    control
integrated into the vessel DP system.
“Plug and play” philosophy adopted for
the vessel integration.. Project Value
£5m. Completion April 2008

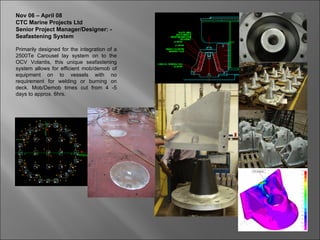

Nov 06 – April 08
CTC Marine Projects Ltd
Senior Project Manager/Designer: -
Seafastening System

Primarily designed for the integration of a
2500Te Carousel lay system on to the
OCV Volantis, this unique seafastening
system allows for efficient mob/demob of
equipment on to vessels with no
requirement for welding or burning on
deck. Mob/Demob times cut from 4 -5
days to approx. 6hrs.
Jan – Sept 06
CTC Marine Projects Limited
Project Manager: -
BP Clair Platform West of Shetland

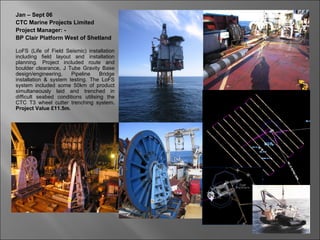

LoFS (Life of Field Seismic) installation
including field layout and installation
planning. Project included route and
boulder clearance, J Tube Gravity Base
design/engineering,    Pipeline     Bridge
installation & system testing. The LoFS
system included some 50km of product
simultaneously laid and trenched in
difficult seabed conditions utilising the
CTC T3 wheel cutter trenching system.
Project Value £11.5m.
Jan - Sept 06
CTC Marine Projects Ltd.
Project Manager: -

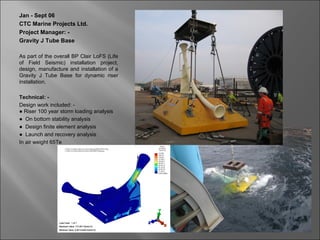

Gravity J Tube Base

As part of the overall BP Clair LoFS (Life
of Field Seismic) installation project,
design, manufacture and installation of a
Gravity J Tube Base for dynamic riser
installation.

Technical: -
Design work included: -
● Riser 100 year storm loading analysis
● On bottom stability analysis
● Design finite element analysis
● Launch and recovery analysis
In air weight 65Te

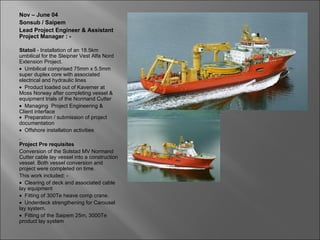

Nov – June 04
Sonsub / Saipem
Lead Project Engineer & Assistant
Project Manager : -

Statoil - Installation of an 18.5km
umbilical for the Sleipner Vest Alfa Nord
Extension Project.
• Umbilical comprised 75mm x 5.5mm
super duplex core with associated
electrical and hydraulic lines
• Product loaded out of Kaverner at
Moss Norway after completing vessel &
equipment trials of the Normand Cutter
• Managing Project Engineering &
Client interface
• Preparation / submission of project
documentation
• Offshore installation activities

Project Pre requisites
Conversion of the Solstad MV Normand
Cutter cable lay vessel into a construction
vessel. Both vessel conversion and
project were completed on time.
This work included: -
• Clearing of deck and associated cable
lay equipment
• Fitting of 300Te heave comp crane.
• Underdeck strengthening for Carousel
lay system.
• Fitting of the Saipem 25m, 3000Te
product lay system

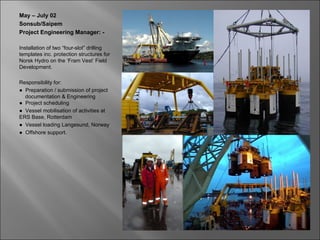

May – July 02
Sonsub/Saipem
Project Engineering Manager: -

Installation of two “four-slot” drilling
templates inc. protection structures for
Norsk Hydro on the ‘Fram Vest’ Field
Development.

Responsibility for:
● Preparation / submission of project
  documentation & Engineering
● Project scheduling
● Vessel mobilisation of activities at
ERS Base, Rotterdam
● Vessel loading Langesund, Norway
● Offshore support.
April - Aug 01
Sonsub/Saipem.
Lead Engineer: -

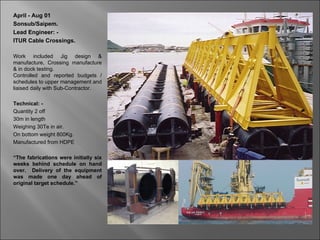

ITUR Cable Crossings.

Work included Jig design &
manufacture, Crossing manufacture
& in dock testing.
Controlled and reported budgets /
schedules to upper management and
liaised daily with Sub-Contractor.

Technical: -
Quantity 2 off
30m in length
Weighing 30Te in air.
On bottom weight 800Kg.
Manufactured from HDPE

“The fabrications were initially six
weeks behind schedule on hand
over. Delivery of the equipment
was made one day ahead of
original target schedule.”

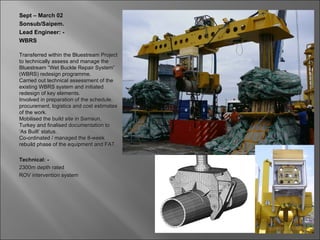

Sept – March 02
Sonsub/Saipem.
Lead Engineer: -
WBRS

Transferred within the Bluestream Project
to technically assess and manage the
Bluestream “Wet Buckle Repair System”
(WBRS) redesign programme.
Carried out technical assessment of the
existing WBRS system and initiated
redesign of key elements.
Involved in preparation of the schedule,
procurement, logistics and cost estimates
of the work.
Mobilised the build site in Samsun,
Turkey and finalised documentation to
‘As Built’ status.
Co-ordinated / managed the 8-week
rebuild phase of the equipment and FAT.

Technical: -
2300m depth rated
ROV intervention system

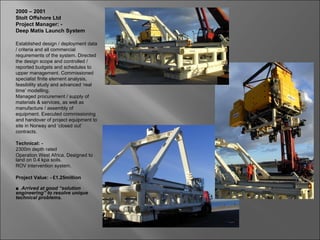

2000 – 2001
Stolt Offshore Ltd
Project Manager: -
Deep Matis Launch System

Established design / deployment data
/ criteria and all commercial
requirements of the system. Directed
the design scope and controlled /
reported budgets and schedules to
upper management. Commissioned
specialist finite element analysis,
feasibility study and advanced ‘real
time’ modelling.
Managed procurement / supply of
materials & services, as well as
manufacture / assembly of
equipment. Executed commissioning
and handover of project equipment to
site in Norway and ‘closed out’
contracts.

Technical: -
2300m depth rated
Operation West Africa. Designed to
land on 0.4 kpa soils.
ROV intervention system.

Project Value: - £1.25million

■ Arrived at good “solution
engineering” to resolve unique
technical problems.

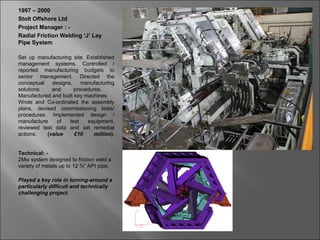

1997 – 2000
Stolt Offshore Ltd
Project Manager : -
Radial Friction Welding ‘J’ Lay
Pipe System

Set up manufacturing site. Established
management systems. Controlled /
reported manufacturing budgets to
senior management. Directed the
conceptual   designs,    manufacturing
solutions    and      procedures.
Manufactured and built key machines
Wrote and Co-ordinated the assembly
plans, devised commissioning tests/
procedures. Implemented design /
manufacture    of   test    equipment,
reviewed test data and set remedial
actions.   (value      £10    million).

Technical: -
2Mw system designed to friction weld a
variety of metals up to 12 ¾” API pipe.

Played a key role in turning-around a
particularly difficult and technically
challenging project.

Trenching Systems        Vessels
                           Bar Protector DSV
  Beluga                  Cygnus
  CMR3 Jetting ROV        Edda Freya
  Flexjet                 Far Samson
  ISU Product Plough
                           Far Sovereign
                           Maersk Advancer
  T1 & T3 Rock Cutter     Maersk Recorder
  UT1 Jet Trencher        Maersk Responder
                           Maxita
                           Normand Cutter
                           Ocean Challenger
                           Polar Prince
                           Seaway Falcon
                           Volantis

Cv supplement-2003-1229274598762649-1

  • 3.
    March 09 –August 2009 Saipem UK Lead Engineer: - Frigg 2009 Decommissioning Campaign Removal of the Quarters Platform (QP) - Pre and post transit survey of the route into the Aker stored facility. Dredging of the pile locations, diamond wire cutting of the piles and one piece removal of the jacket by the S7000 . Removal of the Drilling Platform 1 (DP1) Use of subsea remote intervention technology. Pre-dredging at level one, “piece small” subsea preparation, dismantling, lifting and transfer of jacket sections to subsea storage containers. General seabed debris removal. 11 weeks offshore operations
  • 4.
    May 08 - CTCMarine Projects Limited Senior Project Manager: - BP Shefa II Project 120km lay & burial of Fibre Optic product running from the BP Clair Platform through to the BP Schiehallion FPSO in the north east Atlantic, approximately 140km NNE of Cape Wrath, west of Shetland Islands. Workscope included, Subsea Clamp installation, dynamic riser pull-in and hang off assembly. Product tensioning at the Clair Platform. FOTA deployment at Schiehallion FPSO. Eleven crossings to bridge. Recovery and splicing of BU tails at the FT FO cable intersection. Trenching of the product utilises the CTC T1 Wheel Cutting Tractor & ISU 150te Plough. Construction vessel Maersk Advancer. Project Value £6.5million.
  • 5.
    Nov 06 –April 08 CTC Marine Projects Ltd Senior Project Manager: - Vessel Build. 106m “OCV Volantis” Management of specification and build of the vessel. Designed for Construction/Trenching roles. Development and implementation of many innovative systems enabling the vessel to be configured to meet the various project demands efficiently. Features included “Plug and play” system philosophy, modular container garage and handling system, unique seafastening system and control room. Specialist team consisted of eight persons. Reporting to upper management. Project Value £70m. Delivered April 2008.
  • 6.
    Nov 06 –April 08 CTC Marine Projects Ltd Senior Project Manager: - 2000Te Carousel Lay System Specification and management of lay system including 17m Carousel, Fleeting tower, Accumulator and Tensioner. A modular designed system capable of operation on multiple construction vessels in various configurations. Included vessel hull analysis, grillage design, analysis and build. Incorporated a unique sea fastening system allowing efficient mob/demob. Lay control integrated into the vessel DP system. “Plug and play” philosophy adopted for the vessel integration.. Project Value £5m. Completion April 2008
  • 7.
    Nov 06 –April 08 CTC Marine Projects Ltd Senior Project Manager/Designer: - Seafastening System Primarily designed for the integration of a 2500Te Carousel lay system on to the OCV Volantis, this unique seafastening system allows for efficient mob/demob of equipment on to vessels with no requirement for welding or burning on deck. Mob/Demob times cut from 4 -5 days to approx. 6hrs.
  • 8.
    Jan – Sept06 CTC Marine Projects Limited Project Manager: - BP Clair Platform West of Shetland LoFS (Life of Field Seismic) installation including field layout and installation planning. Project included route and boulder clearance, J Tube Gravity Base design/engineering, Pipeline Bridge installation & system testing. The LoFS system included some 50km of product simultaneously laid and trenched in difficult seabed conditions utilising the CTC T3 wheel cutter trenching system. Project Value £11.5m.
  • 9.
    Jan - Sept06 CTC Marine Projects Ltd. Project Manager: - Gravity J Tube Base As part of the overall BP Clair LoFS (Life of Field Seismic) installation project, design, manufacture and installation of a Gravity J Tube Base for dynamic riser installation. Technical: - Design work included: - ● Riser 100 year storm loading analysis ● On bottom stability analysis ● Design finite element analysis ● Launch and recovery analysis In air weight 65Te
  • 10.
    Nov – June04 Sonsub / Saipem Lead Project Engineer & Assistant Project Manager : - Statoil - Installation of an 18.5km umbilical for the Sleipner Vest Alfa Nord Extension Project. • Umbilical comprised 75mm x 5.5mm super duplex core with associated electrical and hydraulic lines • Product loaded out of Kaverner at Moss Norway after completing vessel & equipment trials of the Normand Cutter • Managing Project Engineering & Client interface • Preparation / submission of project documentation • Offshore installation activities Project Pre requisites Conversion of the Solstad MV Normand Cutter cable lay vessel into a construction vessel. Both vessel conversion and project were completed on time. This work included: - • Clearing of deck and associated cable lay equipment • Fitting of 300Te heave comp crane. • Underdeck strengthening for Carousel lay system. • Fitting of the Saipem 25m, 3000Te product lay system
  • 11.
    May – July02 Sonsub/Saipem Project Engineering Manager: - Installation of two “four-slot” drilling templates inc. protection structures for Norsk Hydro on the ‘Fram Vest’ Field Development. Responsibility for: ● Preparation / submission of project documentation & Engineering ● Project scheduling ● Vessel mobilisation of activities at ERS Base, Rotterdam ● Vessel loading Langesund, Norway ● Offshore support.
  • 12.
    April - Aug01 Sonsub/Saipem. Lead Engineer: - ITUR Cable Crossings. Work included Jig design & manufacture, Crossing manufacture & in dock testing. Controlled and reported budgets / schedules to upper management and liaised daily with Sub-Contractor. Technical: - Quantity 2 off 30m in length Weighing 30Te in air. On bottom weight 800Kg. Manufactured from HDPE “The fabrications were initially six weeks behind schedule on hand over. Delivery of the equipment was made one day ahead of original target schedule.”
  • 13.
    Sept – March02 Sonsub/Saipem. Lead Engineer: - WBRS Transferred within the Bluestream Project to technically assess and manage the Bluestream “Wet Buckle Repair System” (WBRS) redesign programme. Carried out technical assessment of the existing WBRS system and initiated redesign of key elements. Involved in preparation of the schedule, procurement, logistics and cost estimates of the work. Mobilised the build site in Samsun, Turkey and finalised documentation to ‘As Built’ status. Co-ordinated / managed the 8-week rebuild phase of the equipment and FAT. Technical: - 2300m depth rated ROV intervention system
  • 14.
    2000 – 2001 StoltOffshore Ltd Project Manager: - Deep Matis Launch System Established design / deployment data / criteria and all commercial requirements of the system. Directed the design scope and controlled / reported budgets and schedules to upper management. Commissioned specialist finite element analysis, feasibility study and advanced ‘real time’ modelling. Managed procurement / supply of materials & services, as well as manufacture / assembly of equipment. Executed commissioning and handover of project equipment to site in Norway and ‘closed out’ contracts. Technical: - 2300m depth rated Operation West Africa. Designed to land on 0.4 kpa soils. ROV intervention system. Project Value: - £1.25million ■ Arrived at good “solution engineering” to resolve unique technical problems.
  • 15.
    1997 – 2000 StoltOffshore Ltd Project Manager : - Radial Friction Welding ‘J’ Lay Pipe System Set up manufacturing site. Established management systems. Controlled / reported manufacturing budgets to senior management. Directed the conceptual designs, manufacturing solutions and procedures. Manufactured and built key machines Wrote and Co-ordinated the assembly plans, devised commissioning tests/ procedures. Implemented design / manufacture of test equipment, reviewed test data and set remedial actions. (value £10 million). Technical: - 2Mw system designed to friction weld a variety of metals up to 12 ¾” API pipe. Played a key role in turning-around a particularly difficult and technically challenging project.
  • 16.
    Trenching Systems Vessels  Bar Protector DSV  Beluga  Cygnus  CMR3 Jetting ROV  Edda Freya  Flexjet  Far Samson  ISU Product Plough  Far Sovereign  Maersk Advancer  T1 & T3 Rock Cutter  Maersk Recorder  UT1 Jet Trencher  Maersk Responder  Maxita  Normand Cutter  Ocean Challenger  Polar Prince  Seaway Falcon  Volantis
