DEDICATION
I dedicate this work to the God Almighty, who against all odds, provided a
place for my attachment and kept me safe and healthy throughout the
period of my attachment.
ACKNOWLEDGEMENT
I want to acknowledge God for His provision and protection, the
Geochemistry work team; for their support and sacrifices in order to make
my stay a success. I want to specially acknowledge the efforts of my
parents; Barr. & Mrs. Onyeama Obike, for their support and
encouragement. Engr. Kevin Onuchukwu, for his support and
encouragement deserves my invaluable gratitude, Dr. chidi Eneogwe Mr.
Martin Iyasele, Mr. ufot Edet and Mr. Okolosi Samson for making my
industrial training fruitful, to them I say thank you. I will like also to
acknowledge my co-attaches at MPN QIT especially Obi Vitus, Aniefiok
Peters, Okoye Chima and Emmanuel Onyeahara who directed me on how
to go about this work. Finally, I want to appreciate my siblings and all my
friends who in one way or the other contributed to my success in this
Industrial Training to you I say thank you.
INTRODUCTION
The Students Industrial Work Experience Scheme (SIWES) is a skill
acquisition program being coordinated by Industrial Training Fund (ITF),
with the primary aim of exposing students to actual life practices of the
theoretical education, laboratory and workshop practices learnt in tertiary
institutions.
The Twenty-Five (25) weeks of my attachment with EXXONMOBIL
PRODUCING NIGERIA UNLTD, Qua Iboe Terminal has shown me among
other things; Safety measures as integral part of any job (task) to be carried
out, the importance and how to store core samples for future reference and
have also introduced me to various laboratory practices and analysis
amongst others.
CHAPTER 1
SAFETY
1.0 SAFETY ORIENTATION:
In the oil and gas sector the number one priority is SAFETY and so Safety
measures constitute an integral part of any job or task to be carried out. A job is
well done only when it is done safely. Safety is always a priority in any standard
operational establishment. Because of the premium placed on safety, every new
employee of the company undergoes safety training. This is to acquaint the
personnel with the potential hazards associated with his work environment and
how best to mitigate them. During safety orientation, the personnel are
introduced to the ‘operation integrity management system’; a system that gives
guidelines on how best a job could be done to achieve the vision of “NOBODY
GETS HURT”. This orientation is carried out before the personnel are given job
offer letter.
1.1 JOB SAFETY ANALYSIS (JSA):
Job safety analysis is one of the safety tools which states the steps to be take in
carrying out a task, the possible hazards associated with the task and how best
to mitigate them.
Below is a JSA carried out by me during one of our day’s job with me as the Task
Leader.
The Job description for the day was: ARRANGING OF SAMPLE BOXES ACCORDING TO WELLS
Equipment’s used to carry out the day’s task were: FORKLIFT, HARD HAT, SAFTETY SHOES, DUST MASK,
FLAME RESISTANT CLOTHING, SAFETY GLASSES AND LEATHER HAND GLOVES
FIG.1
FIG.2
FIG.3

1.2 SAFETY CHECKS:
This is the very first thing that is done every morning after the opening of the
laboratory. Safety checks involve observing the condition of the laboratory and
laboratory equipment at the time of first entrance. Amongst other things to be
checked are:
(a) The safety shower and eye wash
(b) The pressure and flow rate of compressed gasses
(c) Opening of the exit door.
These checks are carried out in order to ensure safe working condition before the
commencement of the day’s activities.
1.3 TOOL BOX MEETING:
This is done when every member of the work team has arrived. In this meeting,
safety is discussed as it relates to our day to day life (both at work and
elsewhere).
The condition of the work environment is reported, the report of the previous day
is given and the activities for the day mapped out.
1.4 HOUSE KEEPING:
This simply means “keeping every tool or equipment used during work in their
right position after work”. A job is completed only when all things displaced
before or during the task is returned to its original position. Housekeeping is
carried out to prevent common laboratory accidents.
1.5 SAFETY PRESENTATION:
This is done periodically in order to draw the workers attention to safety issues
around the work environment and/or the society at large. Topics such as “Food
Safety”, “Lead Poisoning”, and “Malaria” could be discussed.
1.6 LOSS PREVENTION OBSERVATION (LPO):
This is a check on workers carrying out a task to ensure that standard procedure
is followed in order to avoid incident. If any unsafe act or condition is seen during
the observation, the worker’s attention is drawn to it.
1.7 LABORATORY SAFETY:
The exposure to danger cannot be completely eliminated while working in the
laboratory. For incident prevention, a scientist in the laboratory should never be
careless nor negligent but must always be attentive to duty.
The personal protective equipment (PPE) are the first line of defense while
working in the laboratory. The PPE may vary depending on the analysis to be
done. The basic laboratory personal protective equipment’s are;
(1) Laboratory coat, safety glasses and hand gloves
(2) Safety glasses
(3) Hand gloves
(4) Safety shoes
The safety shower, eye wash and functional first aid box are put in place in case
of incident. The way to these emergency kits must be free from obstruction.
1.8 SHUT DOWN CHECKS:
This is carried out at the end of the day’s work. Various things that might
undermine the safety of the laboratory are checked, they include:
1. Emergency door: The emergency exit door is shut and locked
2. Electrical sockets and electrical equipment: make sure all electrical appliances
in the laboratory are switched off and electrical cords disconnected from power
source, except equipment’s like the gas chromatograph (GC) which can run
overnight.
3. The water taps: All water taps in the laboratory are closed before final exit from
the laboratory.
4. Windows and door: All laboratory windows and doors are closed before
departure from the laboratory.
The last personnel to leave the laboratory should always confirm that the doors
are properly locked.
CHAPTER TWO
SORTING, ARRANGEMENT, INVENTORY AND
TRANSFER OF CORE SAMPLES
2.0 INTRODUCTION:
During the course of my six (6) months attachment the major task carried
out was the sorting, arrangement, inventory and transfer of core samples
from the new geological warehouse to the newly constructed warehouse
and placing it on the assigned location on the rack.
2.1 SORTING:
When the samples come in they come, they are scattered and mixed up
which comprised of the two-third (2/3), One-third (1/3) cores Ditchcuting
samples Core plugs etc. they are now sorted and separated based on the
type of sample.
Core samples are different types which include:
 Two-third (2/3) cores
 One-third (1/3) cores
 Ditchcuting samples
 Core plugs
 Core chips
 Side wall cores
Sorting is done in different categories which include:
 Sorting of samples or cores according to their field
 Sorting of samples according to their well name
 Sorting according to their depths
 Sorting according to their type of drill
Samples from the same oil field, same well are also further sorted
according to the type of drill, which are:
Pilot holes
Horizontal drilling

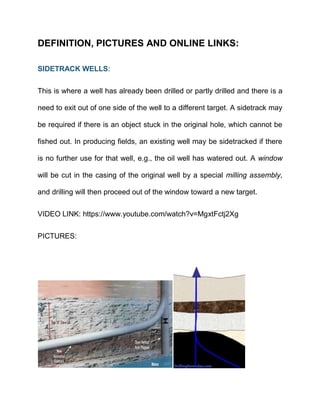

Side track……for definitions, pictures and videos go to page
2.2 ARRANGEMENT:
The samples are arranged according to deep waters and joint venture.
Deep waters: they are the samples gotten from the wells ExxonMobil have
in the high sea e.g. the Ehra.
Joint ventures: are the wells ExxonMobil have in collaboration with NNPC
e.g. Iyak
2.3 INVENTORY
The samples are now recorded according to their arrangements, first in
hard copy before been transferred to the excel spread sheet e.g.:
FIG.4
SAMPLE OF AN INVENTORY
2.4 TRANSFER OF CORE SAMPLES:
Samples are now transferred with the aid of a forklift to the racks
arccording to their location.
WELLNAME TOP DEPTH BOTTOM DEPTH LOCATION REMARK
BOSI-5 (P/H) 4215m 4216m GR27D1 -
BOSI-5 (P/H) 4216m 4217m GR27D1 -
FIG.5
CHAPTER THREE

THE LABORATORY AND LABORATORY OPERATIONS
3.0 INTRODUCTION:
A laboratory is a facility that provides controlled conditions in which scientific
research, experiments and measurements may be performed. The name of a
laboratory and the equipment found in it depends on the type of analysis the
laboratory is used for.
3.1 LABORATORY SETTING:
The laboratory is organized in a way that the safety of the scientist is guaranteed.
The laboratory is always adequately ventilated and its temperature fully
controlled. Safety equipment’s like the eye wash, safety shower, functional fire
extinguisher are put in place of easy accessibility in case of an emergency. The
safety hood/ fume cupboard is always in the laboratory in order to evacuate
fumes and harmful gasses that could be generated during analysis. A
dehumidifier is also recommended, to ensure that the laboratory is free from
humid air. The laboratory has an area marked out for carrying out experiments,
which is the work bench. It has also a storage room and temperature controlled
storage equipment such as refrigerator. In general, a laboratory is set in such a
way that it allows free movement of the worker and easy accessibility of
equipment’s needed.
During the course of my industrial training I was opportune to learn from two
different laboratories, the QIT Laboratory and the Geochemistry Laboratory.
3.2 LABORATORY GUIDELINES:
These are the common behavioral pattern expected of every laboratory
personnel. The personnel should always conduct his or her self in a responsible
manner at all times in the laboratory.
1. Always follow written and verbal instructions carefully and ask questions if part
of a procedure or directive is not understood.
2. It is better not to work alone in the laboratory
3. It is safer to perform only authorized experiments
4. Do not eat food, drink beverages or chew gum in the laboratory. Do not use
laboratory glass wares as containers for food beverages.
5. Avoid horseplay in the laboratory.
6. Always work in a well-ventilated area.
7. Observe good housekeeping practice, Work area should be kept clean and
tidy at all times.
8. Do not neglect any unsafe condition observed
9. Dispose all chemical waste properly
10. Labels, material safety data sheet (MSDS) and equipment instructions must
be read carefully before use
11. Hands should be kept away from face, eyes, mouth, and body while using
chemicals or laboratory equipment’s.
12. Wash hands with soap and water after performing experiment.
13. Personally monitor all experiment at all times
14. Know the locations and operating procedure of all safety equipment,
including first aid kits and fire extinguisher
15. During a fire drill, containers must be closed and electrical equipments turned
off.
16. Dress properly during a laboratory activity; long hair, dangling jewelry, and
loose or baggy clothing are hazard in the laboratory.
17. Shoes should completely cover the foot. A laboratory coat should be worn
during laboratory experiments.
18. Accidents and injury should be reported immediately.
19. All chemicals in the laboratory are to be considered dangerous. Avoid
handling chemicals with fingers.
20. When making an observation keep at least one foot away from the specimen.
21. Do not taste or smell any chemical.
22. Check the label on all chemical bottles twice before removing any of the
contents.
23. Take as much chemical as you need, never return unused chemical to their
original container.

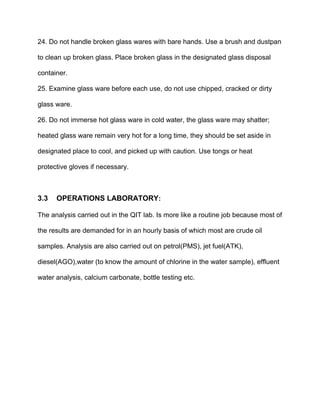

24. Do not handle broken glass wares with bare hands. Use a brush and dustpan
to clean up broken glass. Place broken glass in the designated glass disposal
container.
25. Examine glass ware before each use, do not use chipped, cracked or dirty
glass ware.
26. Do not immerse hot glass ware in cold water, the glass ware may shatter;
heated glass ware remain very hot for a long time, they should be set aside in
designated place to cool, and picked up with caution. Use tongs or heat
protective gloves if necessary.
3.3 OPERATIONS LABORATORY:
The analysis carried out in the QIT lab. Is more like a routine job because most of
the results are demanded for in an hourly basis of which most are crude oil
samples. Analysis are also carried out on petrol(PMS), jet fuel(ATK),
diesel(AGO),water (to know the amount of chlorine in the water sample), effluent
water analysis, calcium carbonate, bottle testing etc.
3.4 EXPERIMENTS DONE, WHY THEY ARE DONE AND THEIR
PROCEDURES:
3.4.1 SEDIMENT AND WATER (S&W):
This is done to know the amount of water in a crude sample; this is carried out
mostly on crude oil samples in the settling tanks.
PROCEDURE:
1. 50ml of xylene which is a solvent is poured into a conical flask
2. The content is made up to a 100ml by the addition of the crude sample.
3. You add some drops of universal demulsifier to the solution
4. Shake properly for about 5mins in oder to have a homogenous solution.
5. After shaking you heat the solution in a water bath for about 10mins so the
xylene and demulsifier can work properly because without heat the crude oil
cannot break out of its emulsion state.
6. after which you centrifuge for another 10mins, at the end of which the water
sinks down and the dry crude oil floats up and you take your reading.
3.4.2 EFFLUENT WATER ANALYSIS (OIL IN WATER):
This is done to check for the amount of oil in water extracted from the crude oil,
this is done in accordance with the law which forbids oil companies from dumping
water with more than 20ppm of oil into the sea to avoid environmental hazard, so
this water is tested in the lab. before it is dumped into the sea. This analysis is
carried out with the help of a spectrophotometer.
PROCEDURE:
1. Produced water is put into a bottle.
2. 10ml of chloroform is added to the sample to push the oil in the water sample
down after which it is left for 10mins.
3. Pure chloroform is used to zero the spectrophotometer, this is used as a buffer
solution so the machine will check only for the amount of oil in the water and not
the chloroform
4. After you must have zeroed the machine you now introduce your main sample
whereby the spectrophotometer measures the transmittance and absorbance of
oil in water.
3.4.3 CALCIUM CARBONATE (CAC03):
CAC03 is an insoluble salt and it is one of the basic salts that cause scale
formation in the pipeline. The essence of the test is to know if there has been
deposition of cac03 on the pipe line and seems caco3 is soluble in water we
collect water samples from the settling tanks, outfall sump and the skimmer pit
for analysis. The company on its own part try their best to avoid deposition of
cac03 by introducing Biocides (scale inhibitors) which kills the bacteria that
reacts with the cac03 to form scales.
PROCEDURE:
1. Put 10ml of produced water in a conical flask
2. Pour 40ml of distilled water into the conical flask to make it up to 50ml.
3. Add 1ml of 8NKOH
4. Add a sachet of calver 2 which is also known as an indicator and swirl the
mixture.
5. Titrate the solution with 0.02N EDTA (ETHYLENE DIAMINETERA ACETIC
ACID) until you a sharp color change from wine red to blue is observed.
6. To calculate for cac03 at end point you multiply your result by x 5 x 20.
3.4.4 DEAN AND STARK:
This is an experiment carried out on export crude to know the amount of water in
the crude oil because most buyers will not want to buy a crude oil that has
more than 0.5s/w in it, so a sample of the export crude is tested before it is been
sold to the buyers.
PROCEDURES:
1. 200ml of crude sample is added to the conical flask
2. 400ml of xylene is also poured into the flask
3. Another 400ml of xylene is heated to know the amount of water in the xylene
because xylene also contains water. At the end of the analysis the amount of
water in the xylene is subtracted from the total amount of water realized.
3. After the mixture you heat the crude for about 2hrs.
Due to the fact that water has a lesser boiling point than xylene it vaporizes and
condenses into the water trap followed by the xylene at a boiling point of 132deg,
after which you take your reading.
3.4.5 DISTILITION OF JET FUEL:
This analysis is carried to check how pure a jet fuel is, this is done with a
distillation machine which has a boiler and condenser in it.
PROCEDURE:
1. 125ml of the jet fuel sample is poured into a round bottom flask with a
thermometer inserted into the flask with the help of a cork.
2. Put on the machine/heat the jet fuel
3. As the heating continues you will notice the gradual rise in temperature after
which you look out for the temperature at which the first drop of fuel enters the
Cylinder at the condensation outlet. (This is known as the initial boiling point of
the jet fuel.
4. You take subsequent note for 10, 20, 50 and 90mins until the temperature
remain constant. (This is known as the final boiling point)
An increase or decrease in the initial or final boiling point implies that the jet fuel
is not pure.

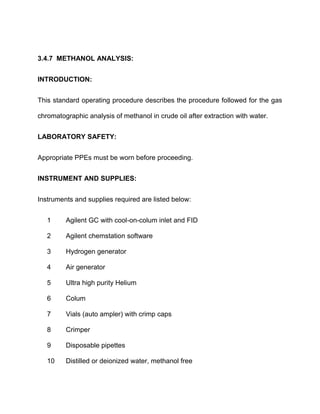

3.4.7 METHANOL ANALYSIS:
INTRODUCTION:
This standard operating procedure describes the procedure followed for the gas
chromatographic analysis of methanol in crude oil after extraction with water.
LABORATORY SAFETY:
Appropriate PPEs must be worn before proceeding.
INSTRUMENT AND SUPPLIES:
Instruments and supplies required are listed below:
1 Agilent GC with cool-on-colum inlet and FID
2 Agilent chemstation software
3 Hydrogen generator
4 Air generator
5 Ultra high purity Helium
6 Colum
7 Vials (auto ampler) with crimp caps
8 Crimper
9 Disposable pipettes
10 Distilled or deionized water, methanol free

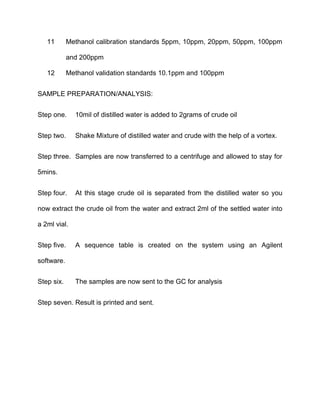

11 Methanol calibration standards 5ppm, 10ppm, 20ppm, 50ppm, 100ppm
and 200ppm
12 Methanol validation standards 10.1ppm and 100ppm
SAMPLE PREPARATION/ANALYSIS:
Step one. 10mil of distilled water is added to 2grams of crude oil
Step two. Shake Mixture of distilled water and crude with the help of a vortex.
Step three. Samples are now transferred to a centrifuge and allowed to stay for
5mins.
Step four. At this stage crude oil is separated from the distilled water so you
now extract the crude oil from the water and extract 2ml of the settled water into
a 2ml vial.
Step five. A sequence table is created on the system using an Agilent
software.
Step six. The samples are now sent to the GC for analysis
Step seven. Result is printed and sent.
CHAPTER 3
OBSERVATION, RECOMEMDATION AND
CONCLUSION
4.0 OBSERVATION:
During the period of my six months Industrial Work experience, I observed some
difficulties and challenges facing the program (SIWES). Below are my observations
Difficulty in securing a place for attachment: It is one of the greatest challenges
facing Industrial training, as students find it difficult to locate companies and firms that
actually do what they are being taught in school and are willing to accept students.
Some students spend half of the time meant for the attachment looking out for places
and at the end may spend less than the supposed number of weeks in the place of
attachment, which may lead to limited learning.
Companies see it as cheap source of labour: some firms take advantage of this
training period, as a cheap source of labour. These firms assign to the students the same
job as the employees and at the end of the month give them nothing or close to nothing
as wage (allowance).
Transportation and accommodation problem: most of the companies do not
provide accommodation, while few provide means transportation for the trainees. This
has been a big problem, together with the fact that some companies do not pay the
students any allowance, so
the students will have to find alternative means of getting money, to sustain them
through the period of attachment.
Hoarding of necessary information by the companies: Some pieces of information
are considered proprietary and are not disclosed to the students. In some firms,
students are not given access to some locations in the company.
Difference in Industrial work experience start off time for various higher
institutions: Because of the difference in difference in academic calendar of institution,
the companies find it difficult to establish a favorable start off time for all students.
Some institution who finish the preceding semester after the companies official start off
time might find it difficult gaining attachment with the company.
Inadequate supervision by the ITF officials: The ITF supervisors that are supposed to
visit the students at their workplace no longer consider it necessary and expect the
students to always come to the area office for signing the industrial training documents.
4.1 RECOMMENDATION:
Having discussed my observation, I think it will be helpful to consider the following
suggestions and recommendation:
A database or log containing the names, locations and other relevant information of
the companies be created and made available to the students; which will aid them in
securing attachment place.
It will be of great help to the students if transport allowance is paid monthly to the
participating students.
The ITF officials should make it a point of duty to supervise the students doing their
attachment in the zone.
Time schedule should be given to the whole higher institutions in Nigeria for an
acceptable start off date or it could be done in batches.
4.2 CONCLUSION:
The students industrial work experience scheme (SIWES) has been very helpful to
students of higher learning in our nation since most of things done in school are
theoretical, but during this period of industrial work experience, the students are
exposed to real life conditions of their discipline. This increases their chances of being
employable after graduation. During this period of attachment, the students are
acquainted with processes and procedures of job application, taking responsibility, and
working with others. My six months industrial work experience has exposed me to
laboratory principles and standard operating procedures and has prepared me for the
future.
DEFINITION, PICTURES AND ONLINE LINKS:
SIDETRACK WELLS:
This is where a well has already been drilled or partly drilled and there is a
need to exit out of one side of the well to a different target. A sidetrack may
be required if there is an object stuck in the original hole, which cannot be
fished out. In producing fields, an existing well may be sidetracked if there
is no further use for that well, e.g., the oil well has watered out. A window
will be cut in the casing of the original well by a special milling assembly,
and drilling will then proceed out of the window toward a new target.
VIDEO LINK: https://www.youtube.com/watch?v=MgxtFctj2Xg
PICTURES:

HORIZONTAL WELLS:
Horizontal wells are wells where the reservoir section is drilled at a high
angle, typically with a trajectory to keep the well within a specific reservoir
interval or hydrocarbon zone.
VIDEO LINK: https://www.youtube.com/watch?v=ufYMgHa0d18

MY SIX MONTHS I T REPORT

  • 1.
    DEDICATION I dedicate thiswork to the God Almighty, who against all odds, provided a place for my attachment and kept me safe and healthy throughout the period of my attachment.
  • 2.
    ACKNOWLEDGEMENT I want toacknowledge God for His provision and protection, the Geochemistry work team; for their support and sacrifices in order to make my stay a success. I want to specially acknowledge the efforts of my parents; Barr. & Mrs. Onyeama Obike, for their support and encouragement. Engr. Kevin Onuchukwu, for his support and encouragement deserves my invaluable gratitude, Dr. chidi Eneogwe Mr. Martin Iyasele, Mr. ufot Edet and Mr. Okolosi Samson for making my industrial training fruitful, to them I say thank you. I will like also to acknowledge my co-attaches at MPN QIT especially Obi Vitus, Aniefiok Peters, Okoye Chima and Emmanuel Onyeahara who directed me on how to go about this work. Finally, I want to appreciate my siblings and all my friends who in one way or the other contributed to my success in this Industrial Training to you I say thank you. INTRODUCTION
  • 3.
    The Students IndustrialWork Experience Scheme (SIWES) is a skill acquisition program being coordinated by Industrial Training Fund (ITF), with the primary aim of exposing students to actual life practices of the theoretical education, laboratory and workshop practices learnt in tertiary institutions. The Twenty-Five (25) weeks of my attachment with EXXONMOBIL PRODUCING NIGERIA UNLTD, Qua Iboe Terminal has shown me among other things; Safety measures as integral part of any job (task) to be carried out, the importance and how to store core samples for future reference and have also introduced me to various laboratory practices and analysis amongst others.
  • 4.
    CHAPTER 1 SAFETY 1.0 SAFETYORIENTATION: In the oil and gas sector the number one priority is SAFETY and so Safety measures constitute an integral part of any job or task to be carried out. A job is well done only when it is done safely. Safety is always a priority in any standard operational establishment. Because of the premium placed on safety, every new employee of the company undergoes safety training. This is to acquaint the personnel with the potential hazards associated with his work environment and how best to mitigate them. During safety orientation, the personnel are introduced to the ‘operation integrity management system’; a system that gives guidelines on how best a job could be done to achieve the vision of “NOBODY GETS HURT”. This orientation is carried out before the personnel are given job offer letter. 1.1 JOB SAFETY ANALYSIS (JSA): Job safety analysis is one of the safety tools which states the steps to be take in carrying out a task, the possible hazards associated with the task and how best to mitigate them.
  • 5.
    Below is aJSA carried out by me during one of our day’s job with me as the Task Leader. The Job description for the day was: ARRANGING OF SAMPLE BOXES ACCORDING TO WELLS Equipment’s used to carry out the day’s task were: FORKLIFT, HARD HAT, SAFTETY SHOES, DUST MASK, FLAME RESISTANT CLOTHING, SAFETY GLASSES AND LEATHER HAND GLOVES FIG.1
  • 6.
  • 7.
    1.2 SAFETY CHECKS: Thisis the very first thing that is done every morning after the opening of the laboratory. Safety checks involve observing the condition of the laboratory and laboratory equipment at the time of first entrance. Amongst other things to be checked are: (a) The safety shower and eye wash (b) The pressure and flow rate of compressed gasses (c) Opening of the exit door. These checks are carried out in order to ensure safe working condition before the commencement of the day’s activities. 1.3 TOOL BOX MEETING: This is done when every member of the work team has arrived. In this meeting, safety is discussed as it relates to our day to day life (both at work and elsewhere). The condition of the work environment is reported, the report of the previous day is given and the activities for the day mapped out. 1.4 HOUSE KEEPING: This simply means “keeping every tool or equipment used during work in their right position after work”. A job is completed only when all things displaced
  • 8.
    before or duringthe task is returned to its original position. Housekeeping is carried out to prevent common laboratory accidents. 1.5 SAFETY PRESENTATION: This is done periodically in order to draw the workers attention to safety issues around the work environment and/or the society at large. Topics such as “Food Safety”, “Lead Poisoning”, and “Malaria” could be discussed. 1.6 LOSS PREVENTION OBSERVATION (LPO): This is a check on workers carrying out a task to ensure that standard procedure is followed in order to avoid incident. If any unsafe act or condition is seen during the observation, the worker’s attention is drawn to it. 1.7 LABORATORY SAFETY: The exposure to danger cannot be completely eliminated while working in the laboratory. For incident prevention, a scientist in the laboratory should never be careless nor negligent but must always be attentive to duty. The personal protective equipment (PPE) are the first line of defense while working in the laboratory. The PPE may vary depending on the analysis to be done. The basic laboratory personal protective equipment’s are; (1) Laboratory coat, safety glasses and hand gloves
  • 9.
    (2) Safety glasses (3)Hand gloves (4) Safety shoes The safety shower, eye wash and functional first aid box are put in place in case of incident. The way to these emergency kits must be free from obstruction. 1.8 SHUT DOWN CHECKS: This is carried out at the end of the day’s work. Various things that might undermine the safety of the laboratory are checked, they include: 1. Emergency door: The emergency exit door is shut and locked 2. Electrical sockets and electrical equipment: make sure all electrical appliances in the laboratory are switched off and electrical cords disconnected from power source, except equipment’s like the gas chromatograph (GC) which can run overnight. 3. The water taps: All water taps in the laboratory are closed before final exit from the laboratory. 4. Windows and door: All laboratory windows and doors are closed before departure from the laboratory. The last personnel to leave the laboratory should always confirm that the doors are properly locked.
  • 10.
    CHAPTER TWO SORTING, ARRANGEMENT,INVENTORY AND TRANSFER OF CORE SAMPLES 2.0 INTRODUCTION: During the course of my six (6) months attachment the major task carried out was the sorting, arrangement, inventory and transfer of core samples from the new geological warehouse to the newly constructed warehouse and placing it on the assigned location on the rack. 2.1 SORTING: When the samples come in they come, they are scattered and mixed up which comprised of the two-third (2/3), One-third (1/3) cores Ditchcuting samples Core plugs etc. they are now sorted and separated based on the type of sample. Core samples are different types which include:  Two-third (2/3) cores  One-third (1/3) cores  Ditchcuting samples
  • 11.
     Core plugs Core chips  Side wall cores Sorting is done in different categories which include:  Sorting of samples or cores according to their field  Sorting of samples according to their well name  Sorting according to their depths  Sorting according to their type of drill Samples from the same oil field, same well are also further sorted according to the type of drill, which are: Pilot holes Horizontal drilling Side track……for definitions, pictures and videos go to page 2.2 ARRANGEMENT: The samples are arranged according to deep waters and joint venture. Deep waters: they are the samples gotten from the wells ExxonMobil have in the high sea e.g. the Ehra.
  • 12.
    Joint ventures: arethe wells ExxonMobil have in collaboration with NNPC e.g. Iyak 2.3 INVENTORY The samples are now recorded according to their arrangements, first in hard copy before been transferred to the excel spread sheet e.g.: FIG.4 SAMPLE OF AN INVENTORY 2.4 TRANSFER OF CORE SAMPLES: Samples are now transferred with the aid of a forklift to the racks arccording to their location. WELLNAME TOP DEPTH BOTTOM DEPTH LOCATION REMARK BOSI-5 (P/H) 4215m 4216m GR27D1 - BOSI-5 (P/H) 4216m 4217m GR27D1 -
  • 13.
  • 14.
    CHAPTER THREE THE LABORATORYAND LABORATORY OPERATIONS 3.0 INTRODUCTION: A laboratory is a facility that provides controlled conditions in which scientific research, experiments and measurements may be performed. The name of a laboratory and the equipment found in it depends on the type of analysis the laboratory is used for. 3.1 LABORATORY SETTING: The laboratory is organized in a way that the safety of the scientist is guaranteed. The laboratory is always adequately ventilated and its temperature fully controlled. Safety equipment’s like the eye wash, safety shower, functional fire extinguisher are put in place of easy accessibility in case of an emergency. The safety hood/ fume cupboard is always in the laboratory in order to evacuate fumes and harmful gasses that could be generated during analysis. A dehumidifier is also recommended, to ensure that the laboratory is free from humid air. The laboratory has an area marked out for carrying out experiments, which is the work bench. It has also a storage room and temperature controlled storage equipment such as refrigerator. In general, a laboratory is set in such a way that it allows free movement of the worker and easy accessibility of equipment’s needed.
  • 15.
    During the courseof my industrial training I was opportune to learn from two different laboratories, the QIT Laboratory and the Geochemistry Laboratory. 3.2 LABORATORY GUIDELINES: These are the common behavioral pattern expected of every laboratory personnel. The personnel should always conduct his or her self in a responsible manner at all times in the laboratory. 1. Always follow written and verbal instructions carefully and ask questions if part of a procedure or directive is not understood. 2. It is better not to work alone in the laboratory 3. It is safer to perform only authorized experiments 4. Do not eat food, drink beverages or chew gum in the laboratory. Do not use laboratory glass wares as containers for food beverages. 5. Avoid horseplay in the laboratory. 6. Always work in a well-ventilated area. 7. Observe good housekeeping practice, Work area should be kept clean and tidy at all times. 8. Do not neglect any unsafe condition observed 9. Dispose all chemical waste properly 10. Labels, material safety data sheet (MSDS) and equipment instructions must be read carefully before use
  • 16.
    11. Hands shouldbe kept away from face, eyes, mouth, and body while using chemicals or laboratory equipment’s. 12. Wash hands with soap and water after performing experiment. 13. Personally monitor all experiment at all times 14. Know the locations and operating procedure of all safety equipment, including first aid kits and fire extinguisher 15. During a fire drill, containers must be closed and electrical equipments turned off. 16. Dress properly during a laboratory activity; long hair, dangling jewelry, and loose or baggy clothing are hazard in the laboratory. 17. Shoes should completely cover the foot. A laboratory coat should be worn during laboratory experiments. 18. Accidents and injury should be reported immediately. 19. All chemicals in the laboratory are to be considered dangerous. Avoid handling chemicals with fingers. 20. When making an observation keep at least one foot away from the specimen. 21. Do not taste or smell any chemical. 22. Check the label on all chemical bottles twice before removing any of the contents. 23. Take as much chemical as you need, never return unused chemical to their original container.
  • 17.
    24. Do nothandle broken glass wares with bare hands. Use a brush and dustpan to clean up broken glass. Place broken glass in the designated glass disposal container. 25. Examine glass ware before each use, do not use chipped, cracked or dirty glass ware. 26. Do not immerse hot glass ware in cold water, the glass ware may shatter; heated glass ware remain very hot for a long time, they should be set aside in designated place to cool, and picked up with caution. Use tongs or heat protective gloves if necessary. 3.3 OPERATIONS LABORATORY: The analysis carried out in the QIT lab. Is more like a routine job because most of the results are demanded for in an hourly basis of which most are crude oil samples. Analysis are also carried out on petrol(PMS), jet fuel(ATK), diesel(AGO),water (to know the amount of chlorine in the water sample), effluent water analysis, calcium carbonate, bottle testing etc.
  • 18.
    3.4 EXPERIMENTS DONE,WHY THEY ARE DONE AND THEIR PROCEDURES: 3.4.1 SEDIMENT AND WATER (S&W): This is done to know the amount of water in a crude sample; this is carried out mostly on crude oil samples in the settling tanks. PROCEDURE: 1. 50ml of xylene which is a solvent is poured into a conical flask 2. The content is made up to a 100ml by the addition of the crude sample. 3. You add some drops of universal demulsifier to the solution 4. Shake properly for about 5mins in oder to have a homogenous solution. 5. After shaking you heat the solution in a water bath for about 10mins so the xylene and demulsifier can work properly because without heat the crude oil cannot break out of its emulsion state. 6. after which you centrifuge for another 10mins, at the end of which the water sinks down and the dry crude oil floats up and you take your reading. 3.4.2 EFFLUENT WATER ANALYSIS (OIL IN WATER): This is done to check for the amount of oil in water extracted from the crude oil, this is done in accordance with the law which forbids oil companies from dumping water with more than 20ppm of oil into the sea to avoid environmental hazard, so
  • 19.
    this water istested in the lab. before it is dumped into the sea. This analysis is carried out with the help of a spectrophotometer. PROCEDURE: 1. Produced water is put into a bottle. 2. 10ml of chloroform is added to the sample to push the oil in the water sample down after which it is left for 10mins. 3. Pure chloroform is used to zero the spectrophotometer, this is used as a buffer solution so the machine will check only for the amount of oil in the water and not the chloroform 4. After you must have zeroed the machine you now introduce your main sample whereby the spectrophotometer measures the transmittance and absorbance of oil in water. 3.4.3 CALCIUM CARBONATE (CAC03): CAC03 is an insoluble salt and it is one of the basic salts that cause scale formation in the pipeline. The essence of the test is to know if there has been deposition of cac03 on the pipe line and seems caco3 is soluble in water we collect water samples from the settling tanks, outfall sump and the skimmer pit for analysis. The company on its own part try their best to avoid deposition of cac03 by introducing Biocides (scale inhibitors) which kills the bacteria that reacts with the cac03 to form scales. PROCEDURE:
  • 20.
    1. Put 10mlof produced water in a conical flask 2. Pour 40ml of distilled water into the conical flask to make it up to 50ml. 3. Add 1ml of 8NKOH 4. Add a sachet of calver 2 which is also known as an indicator and swirl the mixture. 5. Titrate the solution with 0.02N EDTA (ETHYLENE DIAMINETERA ACETIC ACID) until you a sharp color change from wine red to blue is observed. 6. To calculate for cac03 at end point you multiply your result by x 5 x 20. 3.4.4 DEAN AND STARK: This is an experiment carried out on export crude to know the amount of water in the crude oil because most buyers will not want to buy a crude oil that has more than 0.5s/w in it, so a sample of the export crude is tested before it is been sold to the buyers. PROCEDURES: 1. 200ml of crude sample is added to the conical flask 2. 400ml of xylene is also poured into the flask 3. Another 400ml of xylene is heated to know the amount of water in the xylene because xylene also contains water. At the end of the analysis the amount of water in the xylene is subtracted from the total amount of water realized. 3. After the mixture you heat the crude for about 2hrs.
  • 21.
    Due to thefact that water has a lesser boiling point than xylene it vaporizes and condenses into the water trap followed by the xylene at a boiling point of 132deg, after which you take your reading. 3.4.5 DISTILITION OF JET FUEL: This analysis is carried to check how pure a jet fuel is, this is done with a distillation machine which has a boiler and condenser in it. PROCEDURE: 1. 125ml of the jet fuel sample is poured into a round bottom flask with a thermometer inserted into the flask with the help of a cork. 2. Put on the machine/heat the jet fuel 3. As the heating continues you will notice the gradual rise in temperature after which you look out for the temperature at which the first drop of fuel enters the Cylinder at the condensation outlet. (This is known as the initial boiling point of the jet fuel. 4. You take subsequent note for 10, 20, 50 and 90mins until the temperature remain constant. (This is known as the final boiling point) An increase or decrease in the initial or final boiling point implies that the jet fuel is not pure.
  • 22.
    3.4.7 METHANOL ANALYSIS: INTRODUCTION: Thisstandard operating procedure describes the procedure followed for the gas chromatographic analysis of methanol in crude oil after extraction with water. LABORATORY SAFETY: Appropriate PPEs must be worn before proceeding. INSTRUMENT AND SUPPLIES: Instruments and supplies required are listed below: 1 Agilent GC with cool-on-colum inlet and FID 2 Agilent chemstation software 3 Hydrogen generator 4 Air generator 5 Ultra high purity Helium 6 Colum 7 Vials (auto ampler) with crimp caps 8 Crimper 9 Disposable pipettes 10 Distilled or deionized water, methanol free
  • 23.
    11 Methanol calibrationstandards 5ppm, 10ppm, 20ppm, 50ppm, 100ppm and 200ppm 12 Methanol validation standards 10.1ppm and 100ppm SAMPLE PREPARATION/ANALYSIS: Step one. 10mil of distilled water is added to 2grams of crude oil Step two. Shake Mixture of distilled water and crude with the help of a vortex. Step three. Samples are now transferred to a centrifuge and allowed to stay for 5mins. Step four. At this stage crude oil is separated from the distilled water so you now extract the crude oil from the water and extract 2ml of the settled water into a 2ml vial. Step five. A sequence table is created on the system using an Agilent software. Step six. The samples are now sent to the GC for analysis Step seven. Result is printed and sent.
  • 24.
    CHAPTER 3 OBSERVATION, RECOMEMDATIONAND CONCLUSION 4.0 OBSERVATION: During the period of my six months Industrial Work experience, I observed some difficulties and challenges facing the program (SIWES). Below are my observations Difficulty in securing a place for attachment: It is one of the greatest challenges facing Industrial training, as students find it difficult to locate companies and firms that actually do what they are being taught in school and are willing to accept students. Some students spend half of the time meant for the attachment looking out for places and at the end may spend less than the supposed number of weeks in the place of attachment, which may lead to limited learning. Companies see it as cheap source of labour: some firms take advantage of this training period, as a cheap source of labour. These firms assign to the students the same job as the employees and at the end of the month give them nothing or close to nothing as wage (allowance). Transportation and accommodation problem: most of the companies do not provide accommodation, while few provide means transportation for the trainees. This
  • 25.
    has been abig problem, together with the fact that some companies do not pay the students any allowance, so the students will have to find alternative means of getting money, to sustain them through the period of attachment. Hoarding of necessary information by the companies: Some pieces of information are considered proprietary and are not disclosed to the students. In some firms, students are not given access to some locations in the company. Difference in Industrial work experience start off time for various higher institutions: Because of the difference in difference in academic calendar of institution, the companies find it difficult to establish a favorable start off time for all students. Some institution who finish the preceding semester after the companies official start off time might find it difficult gaining attachment with the company. Inadequate supervision by the ITF officials: The ITF supervisors that are supposed to visit the students at their workplace no longer consider it necessary and expect the students to always come to the area office for signing the industrial training documents. 4.1 RECOMMENDATION: Having discussed my observation, I think it will be helpful to consider the following suggestions and recommendation:
  • 26.
    A database orlog containing the names, locations and other relevant information of the companies be created and made available to the students; which will aid them in securing attachment place. It will be of great help to the students if transport allowance is paid monthly to the participating students. The ITF officials should make it a point of duty to supervise the students doing their attachment in the zone. Time schedule should be given to the whole higher institutions in Nigeria for an acceptable start off date or it could be done in batches. 4.2 CONCLUSION: The students industrial work experience scheme (SIWES) has been very helpful to students of higher learning in our nation since most of things done in school are theoretical, but during this period of industrial work experience, the students are exposed to real life conditions of their discipline. This increases their chances of being employable after graduation. During this period of attachment, the students are acquainted with processes and procedures of job application, taking responsibility, and working with others. My six months industrial work experience has exposed me to laboratory principles and standard operating procedures and has prepared me for the future.
  • 27.
    DEFINITION, PICTURES ANDONLINE LINKS: SIDETRACK WELLS: This is where a well has already been drilled or partly drilled and there is a need to exit out of one side of the well to a different target. A sidetrack may be required if there is an object stuck in the original hole, which cannot be fished out. In producing fields, an existing well may be sidetracked if there is no further use for that well, e.g., the oil well has watered out. A window will be cut in the casing of the original well by a special milling assembly, and drilling will then proceed out of the window toward a new target. VIDEO LINK: https://www.youtube.com/watch?v=MgxtFctj2Xg PICTURES:
  • 28.
    HORIZONTAL WELLS: Horizontal wellsare wells where the reservoir section is drilled at a high angle, typically with a trajectory to keep the well within a specific reservoir interval or hydrocarbon zone. VIDEO LINK: https://www.youtube.com/watch?v=ufYMgHa0d18
