Monthly Progress Report
DAMAC Heights at Dubai Marina
Report No.7 - September 2014
Submitted to
DAMAC Gulf Properties Co. LLC
P.O.BOX 2195, Dubai
United Arab Emirates
Monthly Progress Report - September 2014
Prepared for
Damac Properties Co. LLC
P.O.Box 2195, Dubai
United Arab Emirates
Prepared by
AECOM Middle East Limited
ايست ليمتد ϝ وم ميد Ϝ اي
PO Box 51028, Dubai
United Arab Emirates
www.aecom.com
30.Sep.14
© AECOM 2014
The information contained in this document produced by AECOM Middle
East Limited is solely for the use of the Client identified on the cover sheet
for the purpose for which it has been prepared and AECOM Middle East
Limited undertakes no duty to or accepts any responsibility to any third party
who may rely upon this document.
All rights reserved. No section or element of this document may be removed from this document, reproduced, electronically stored or transmitted in any form without the
written permission of AECOM Middle East Limited.
Quality Information
Document
Monthly Progress Report - September 2014
Ref Date 16.Okt.14
Prepared by Sameh Kandil Reviewed by
Revision History
Fuad Hasan/Tareq Al Emam
Authorised
Name/Position Signature
Project Director
Revision Revision Date Details
0 16.Okt.14
2

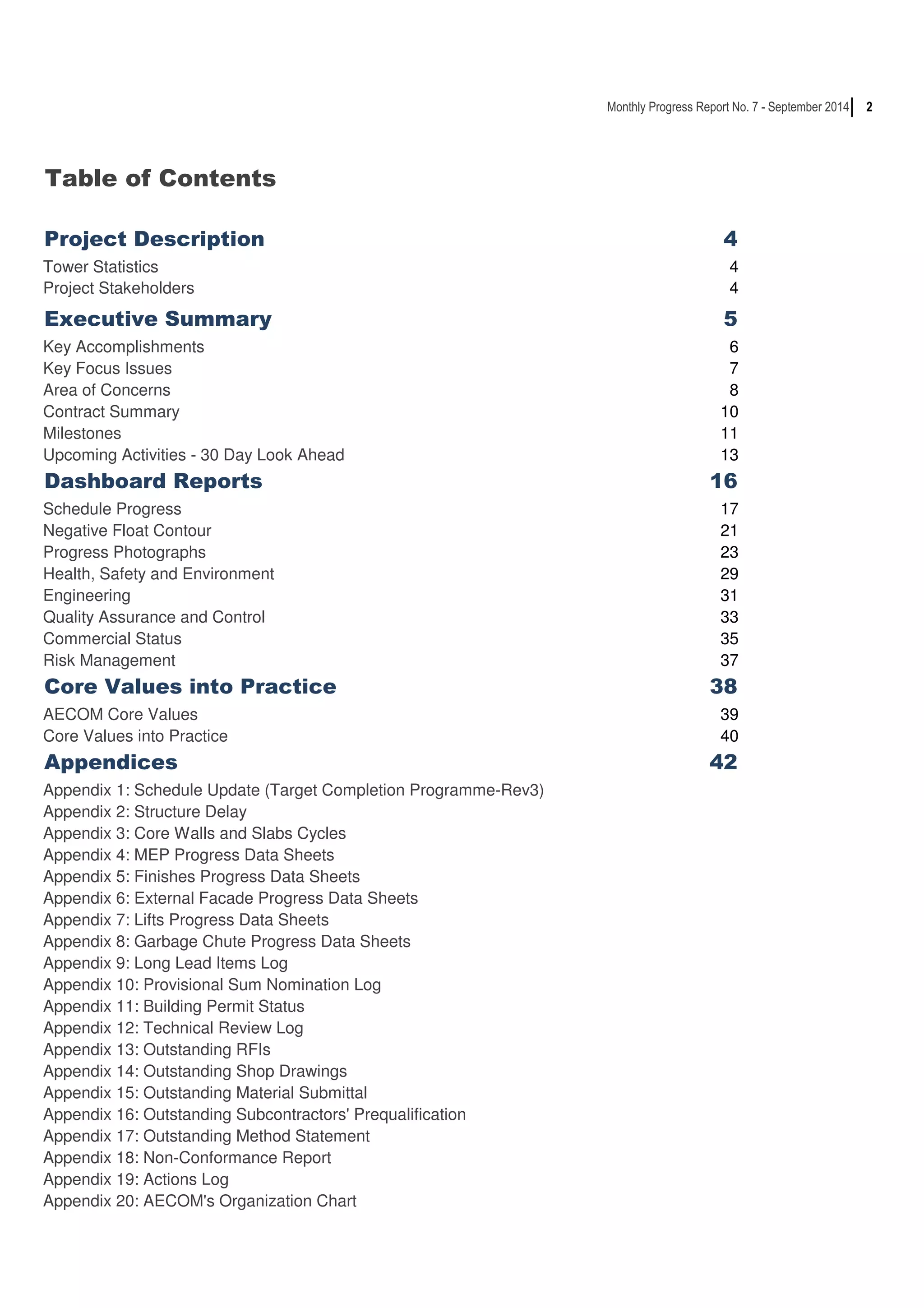

Table of Contents
Monthly Progress Report No. 7 - September 2014
Project Description 4
Tower Statistics 4
Project Stakeholders 4
Executive Summary 5
Key Accomplishments 6
Key Focus Issues 7

Area of Concerns 8

Contract Summary 10
Milestones 11

Upcoming Activities - 30 Day Look Ahead 13
Dashboard Reports 16

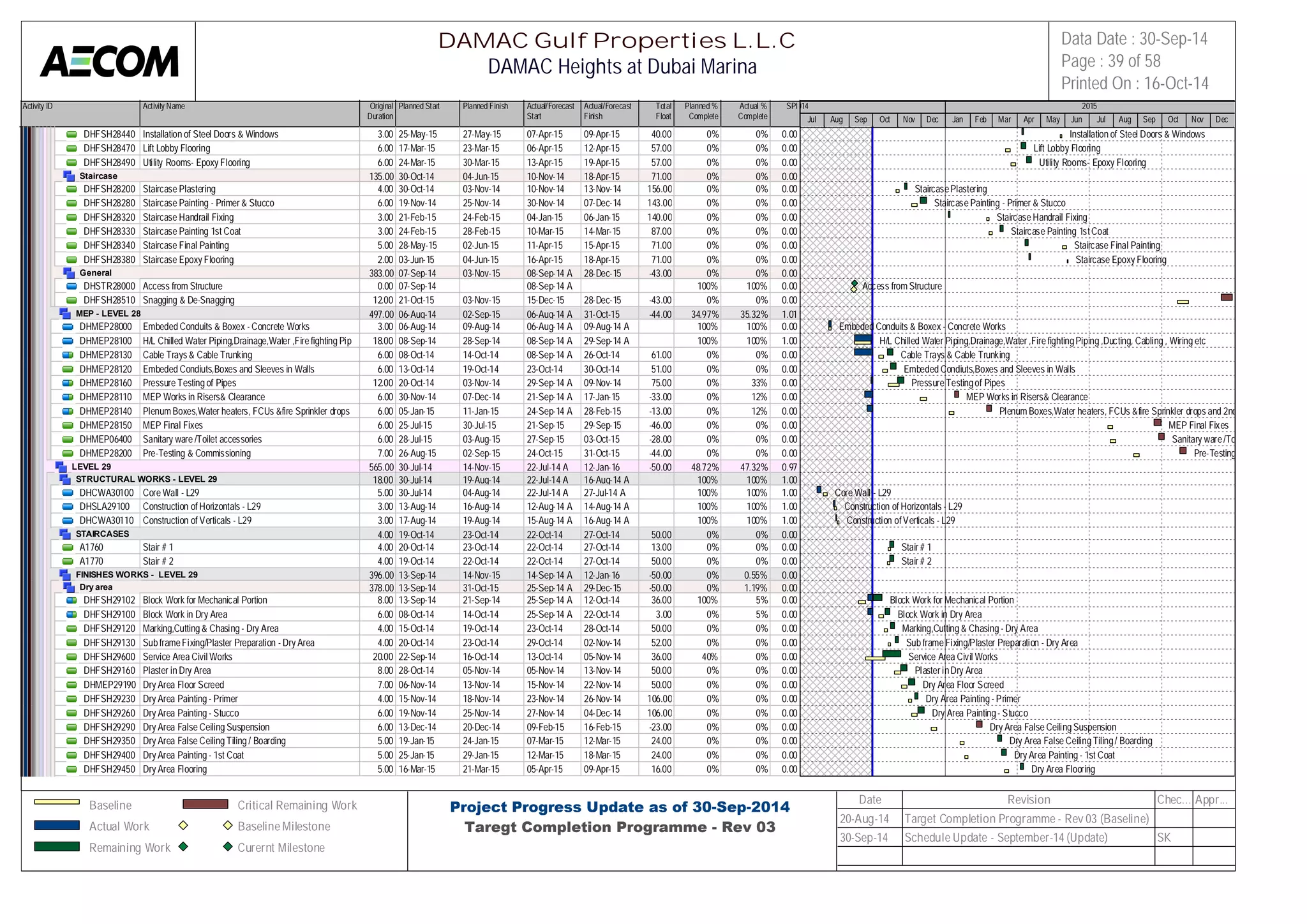

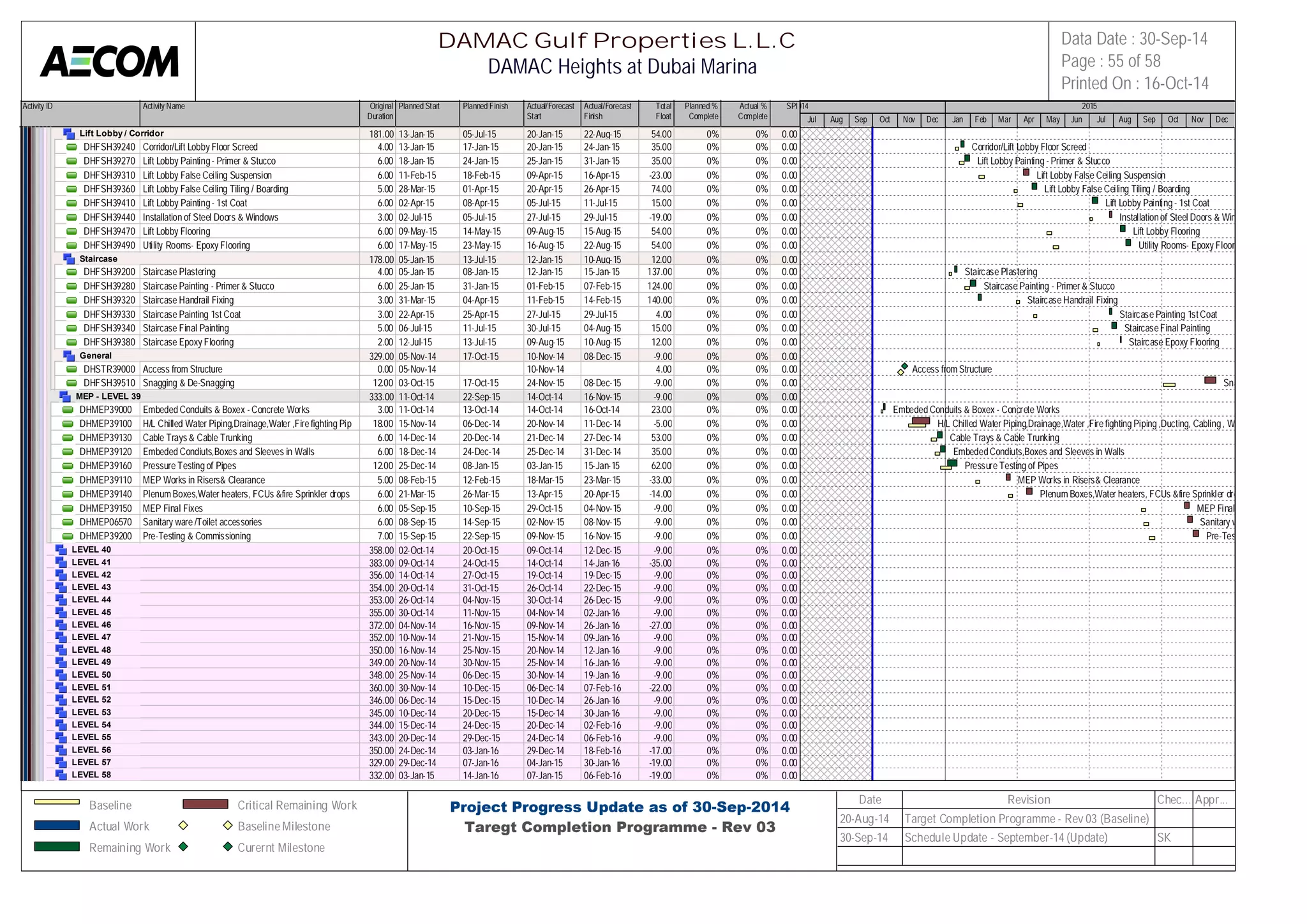

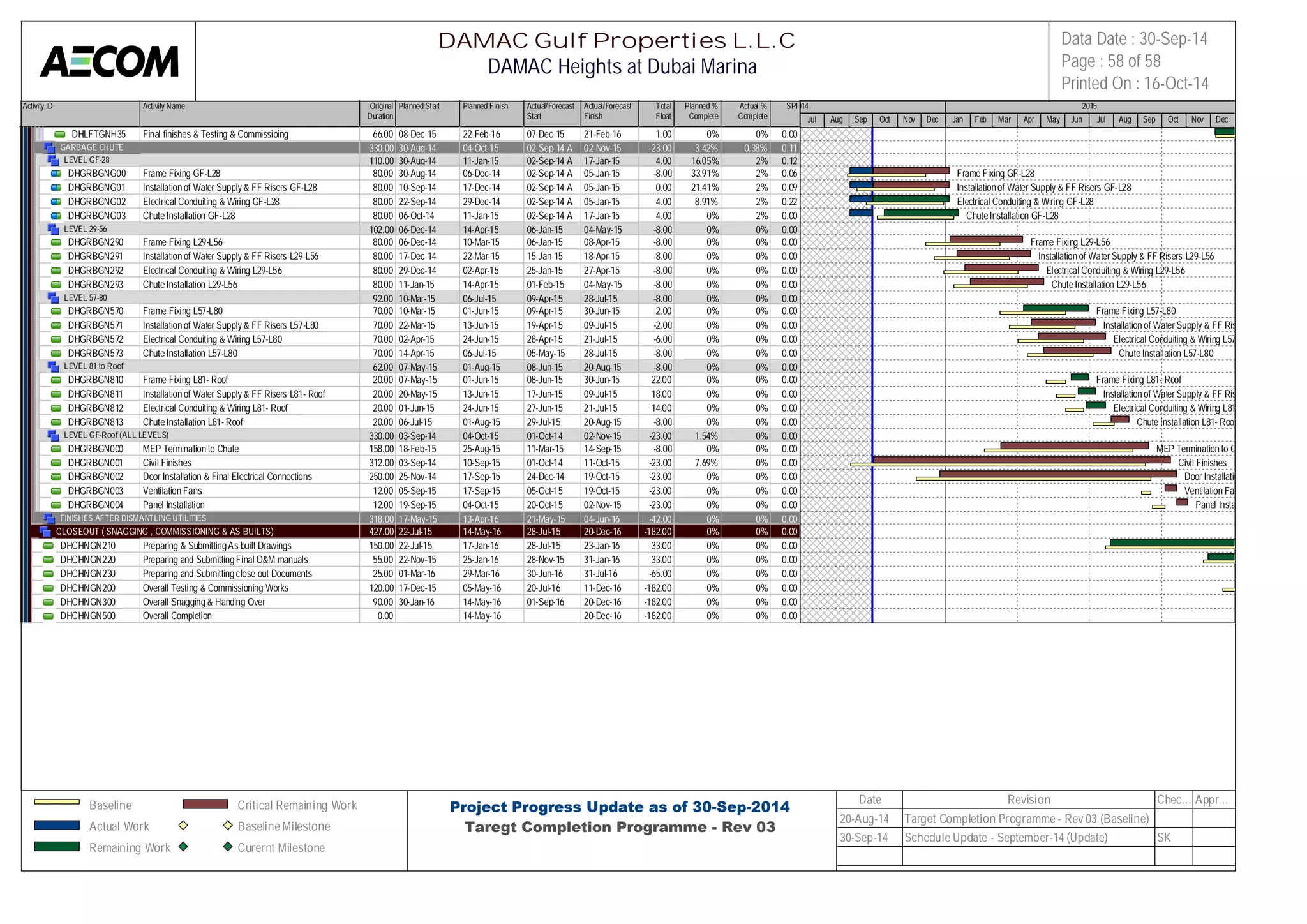

Schedule Progress 17

Negative Float Contour 21

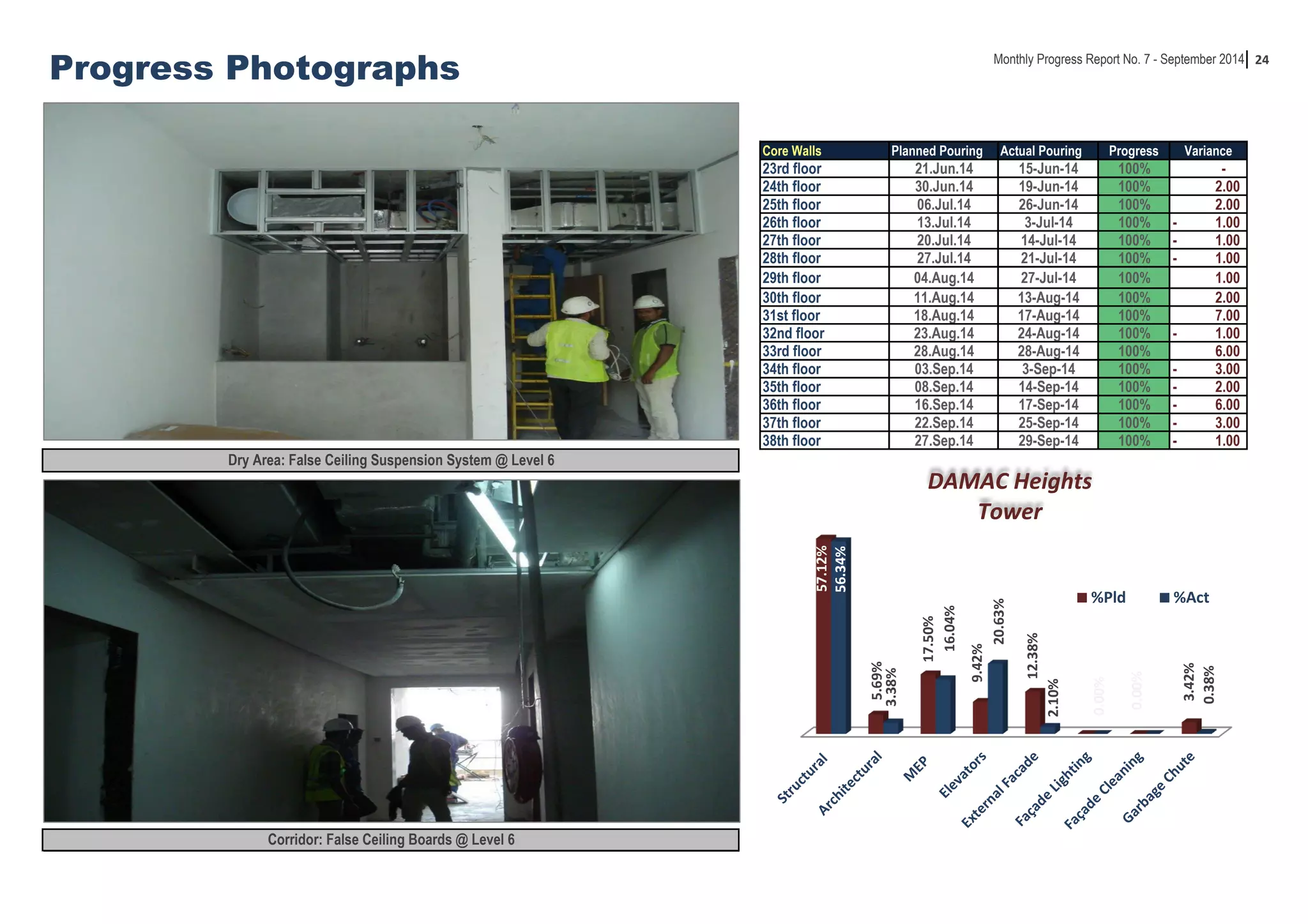

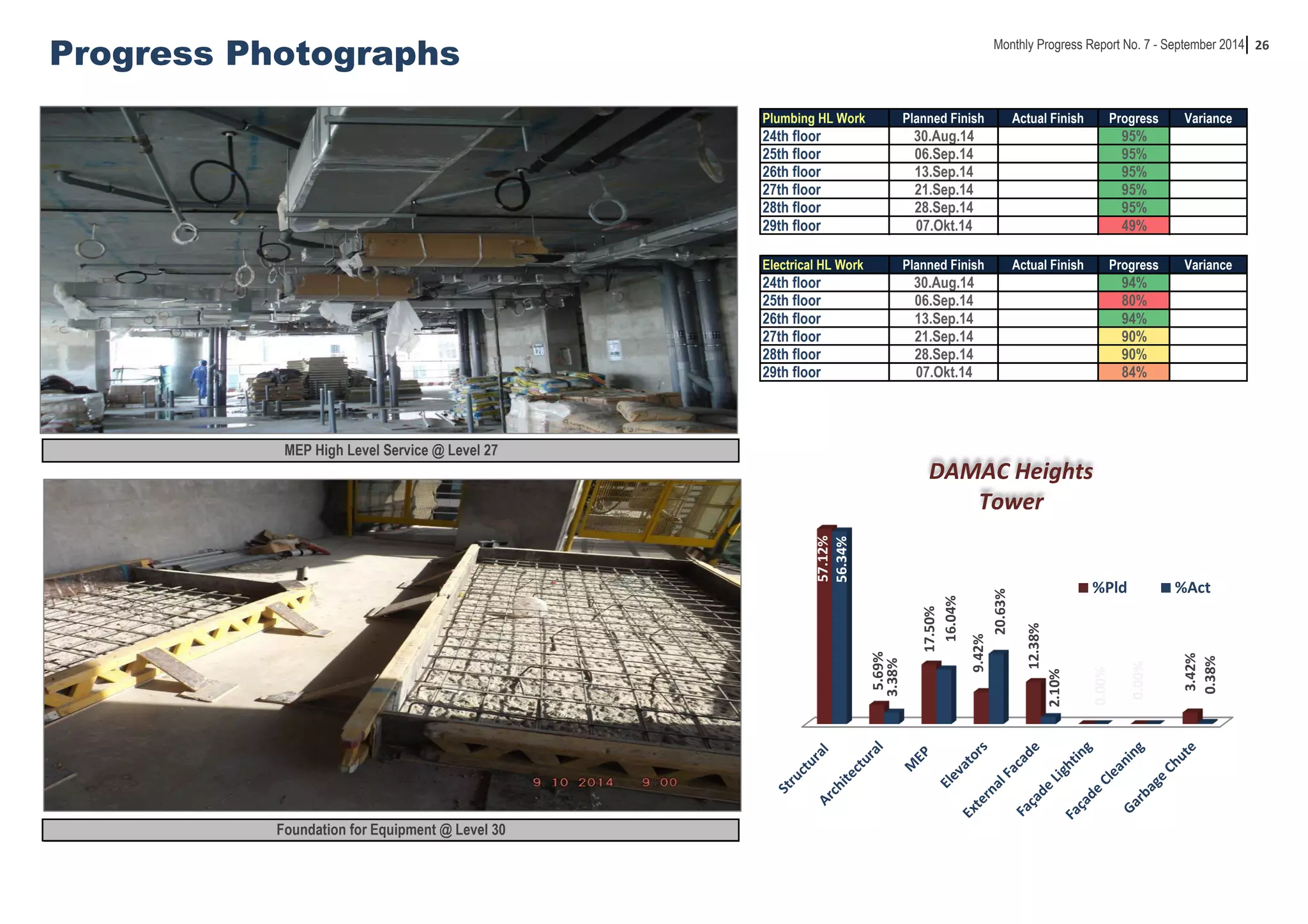

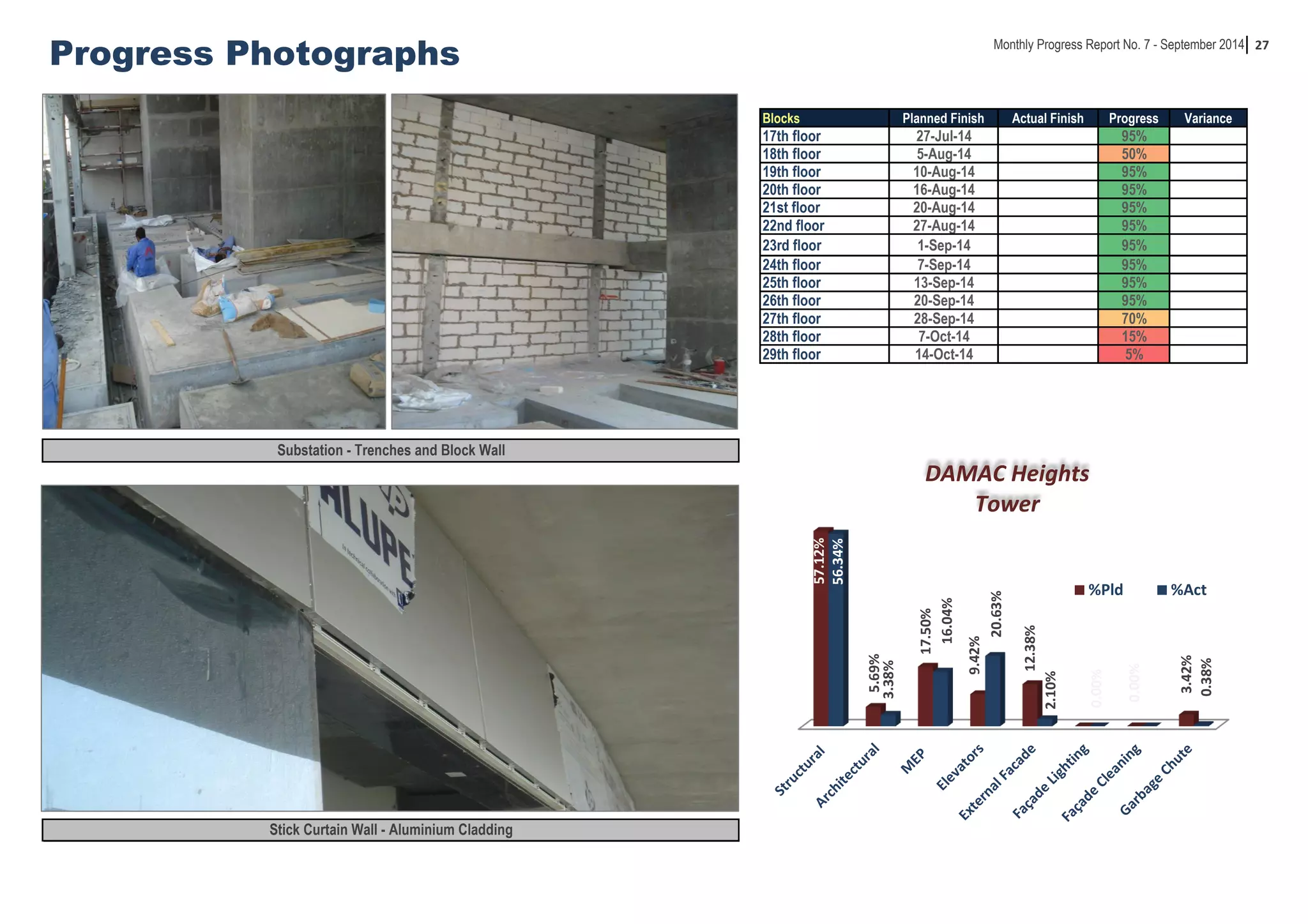

Progress Photographs 23
Health, Safety and Environment 29
Engineering 31
Quality Assurance and Control 33
Commercial Status 35

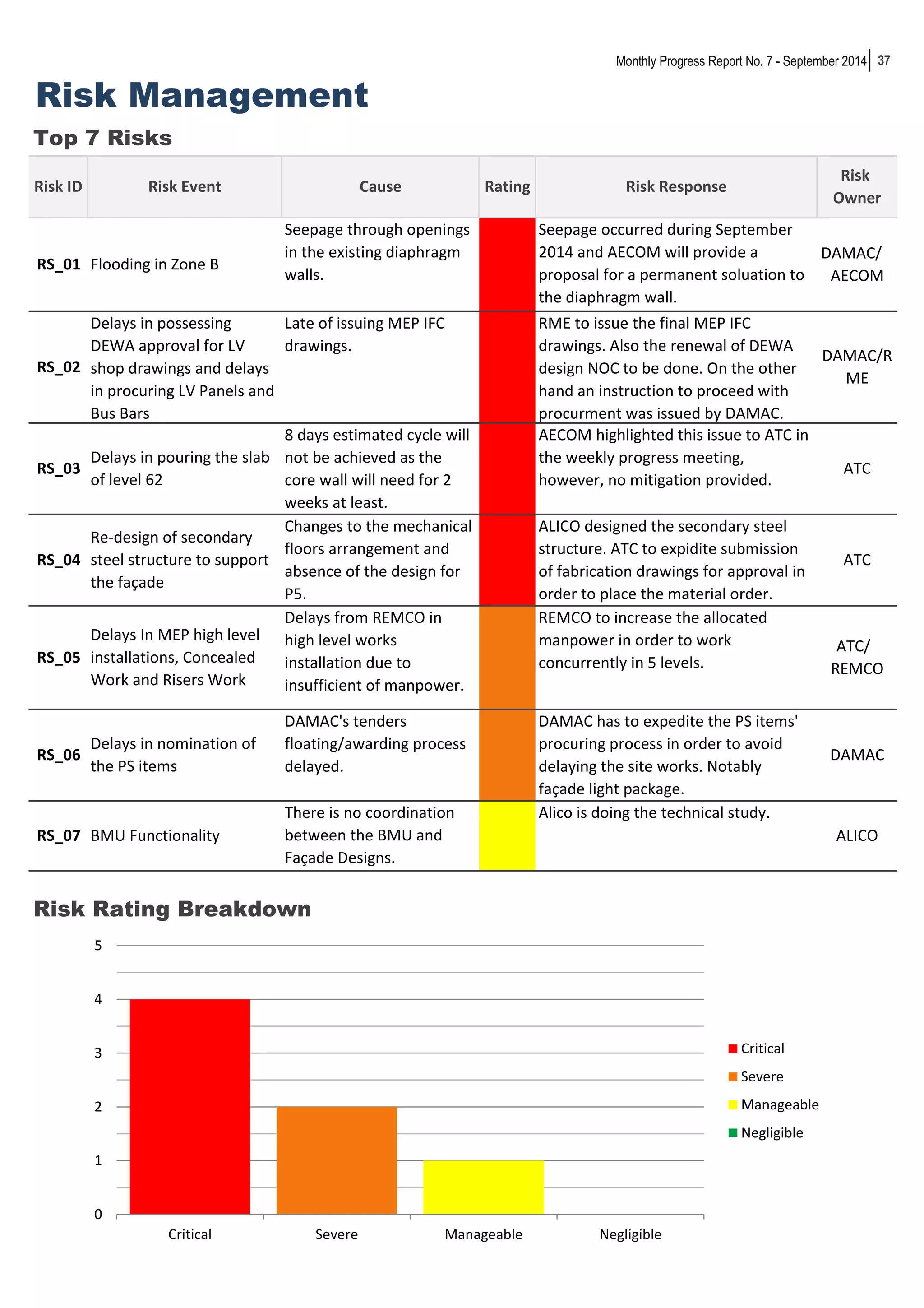

Risk Management 37
Core Values into Practice 38
AECOM Core Values 39
Core Values into Practice 40
Appendices 42

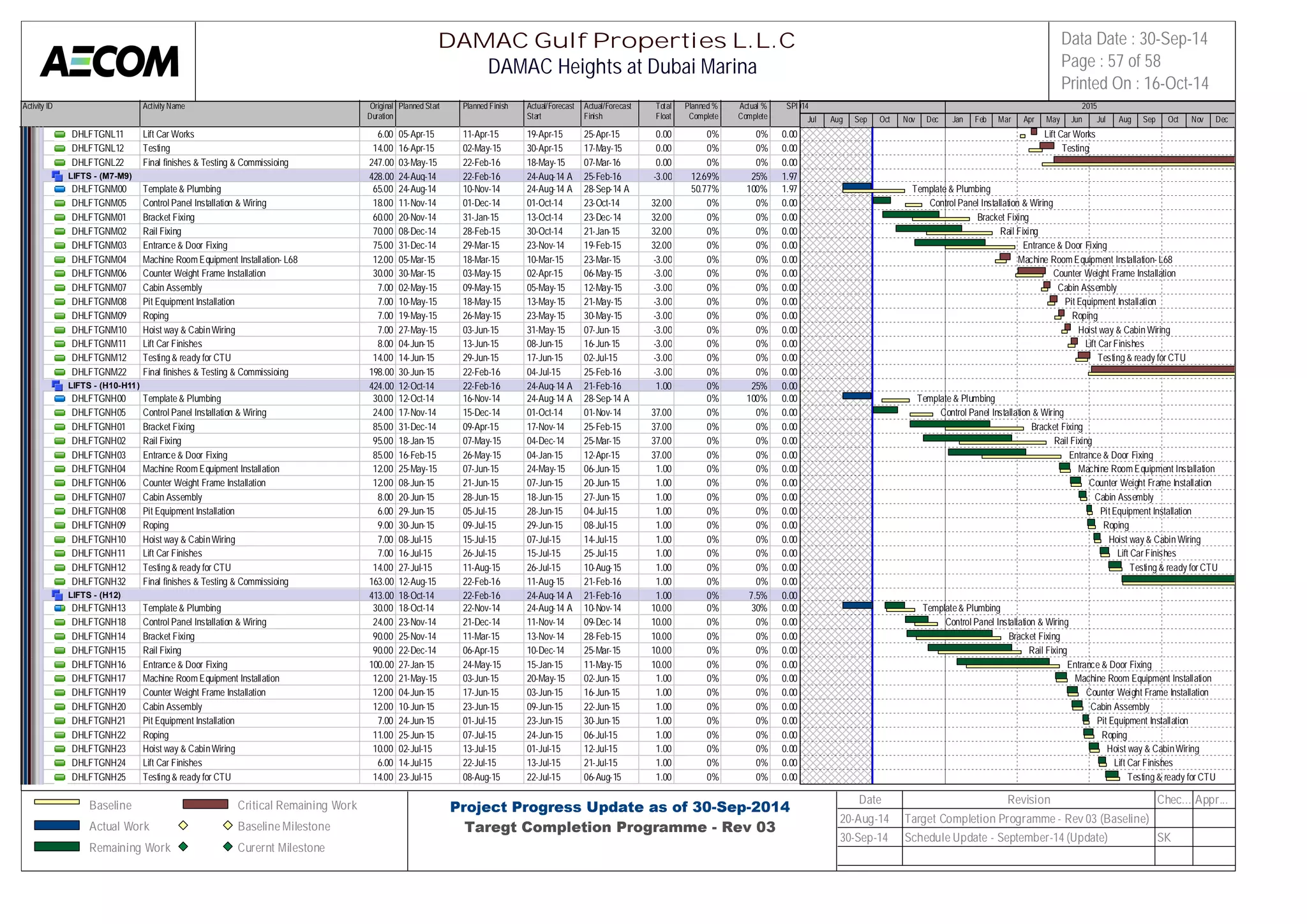

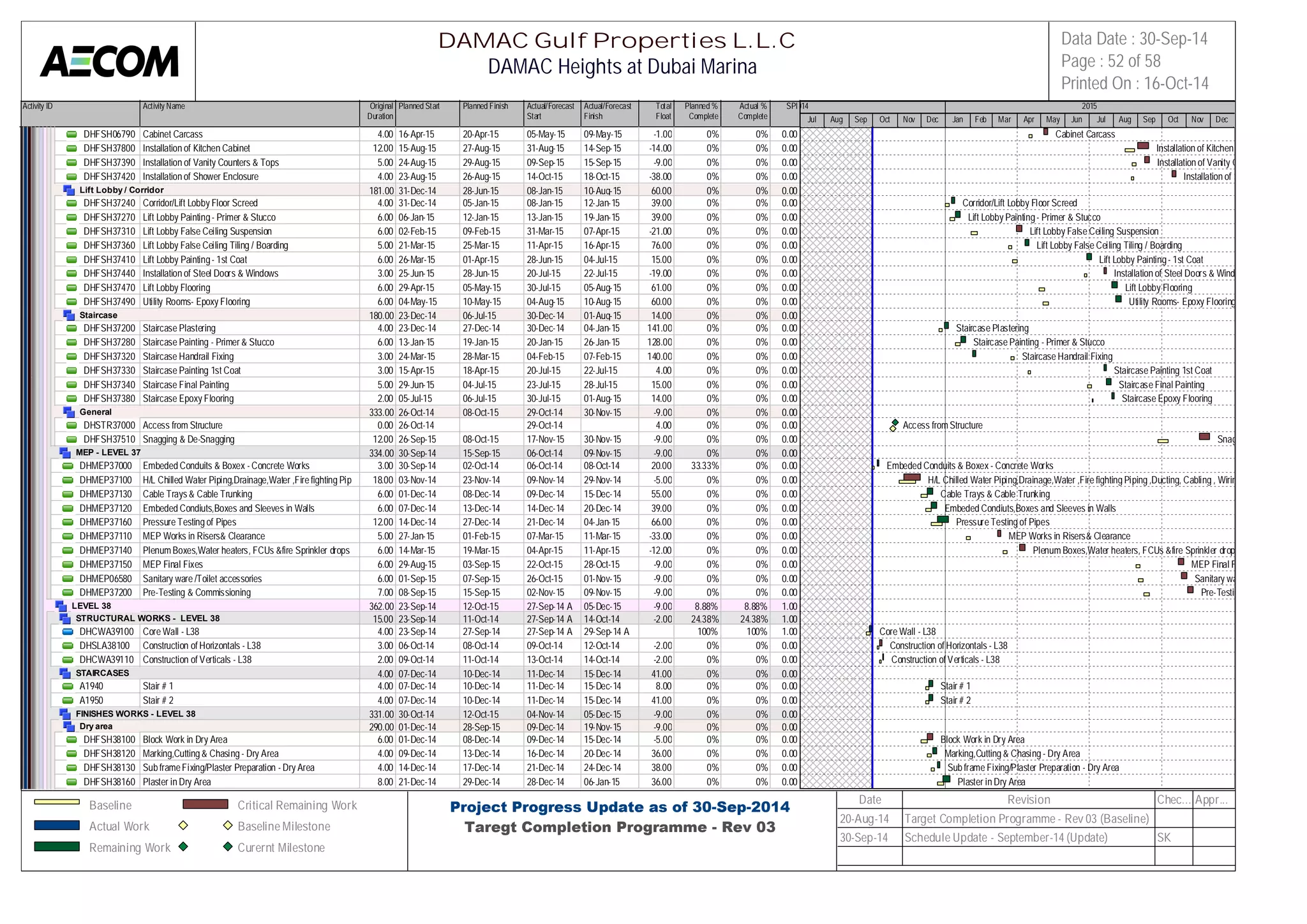

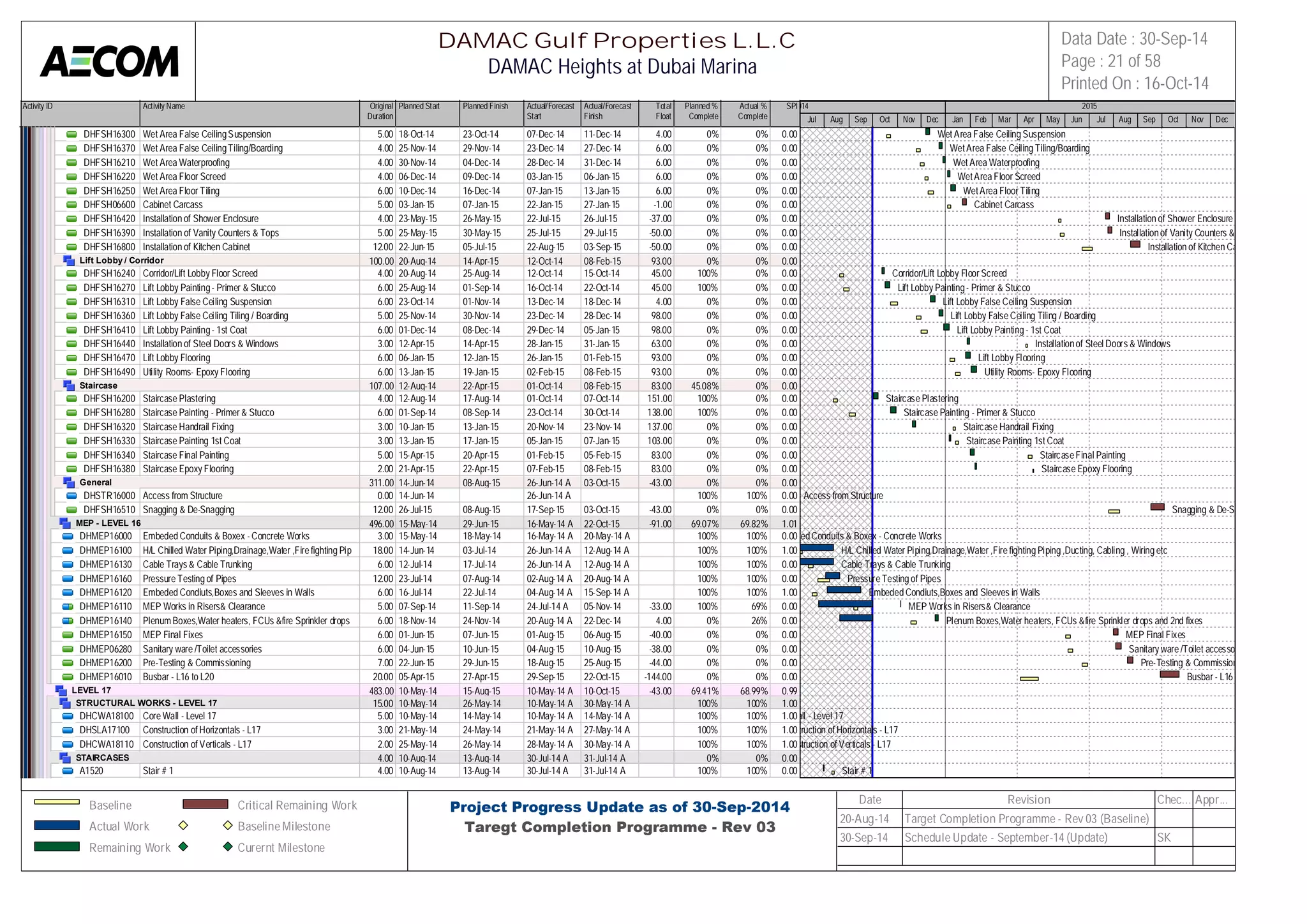

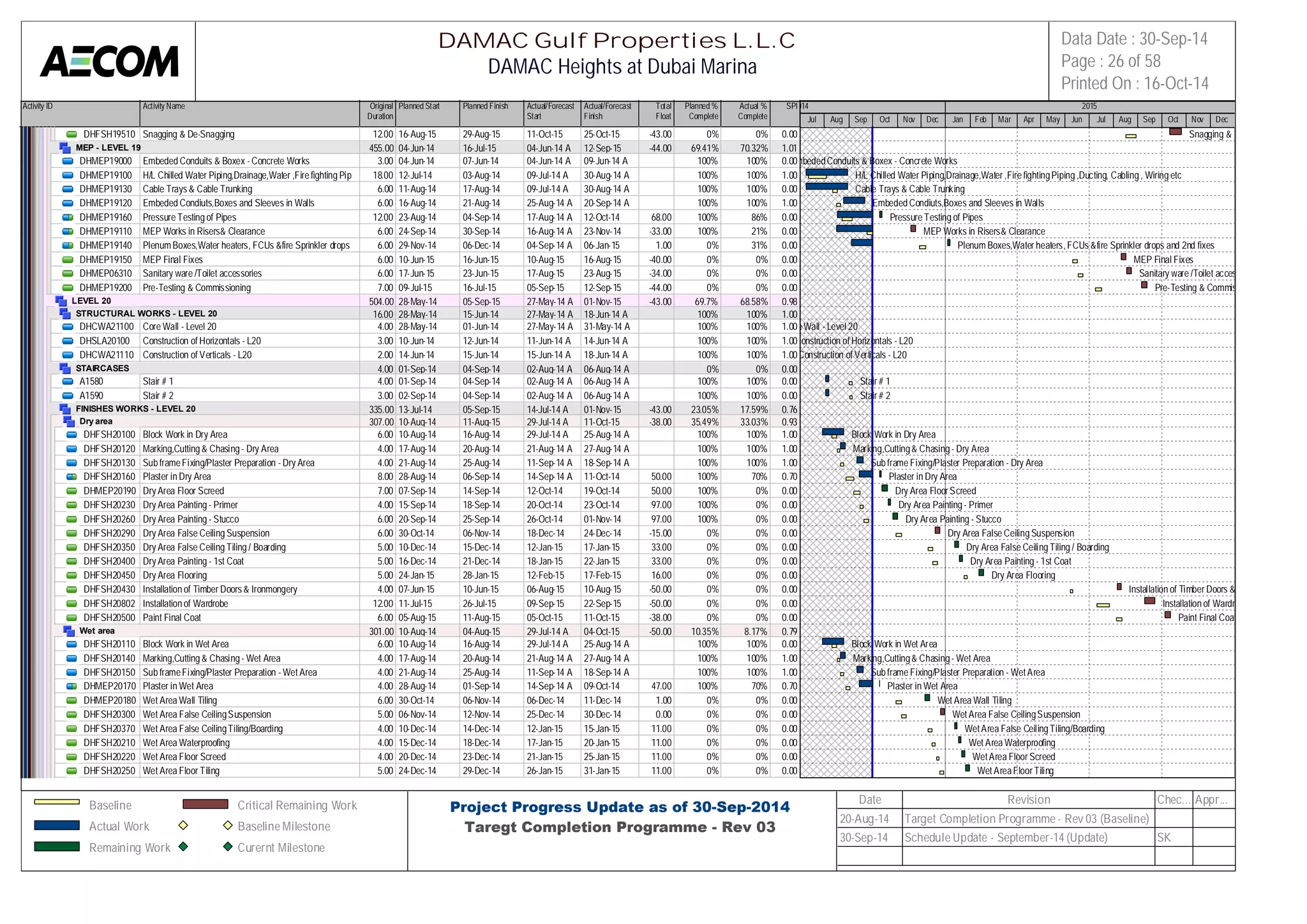

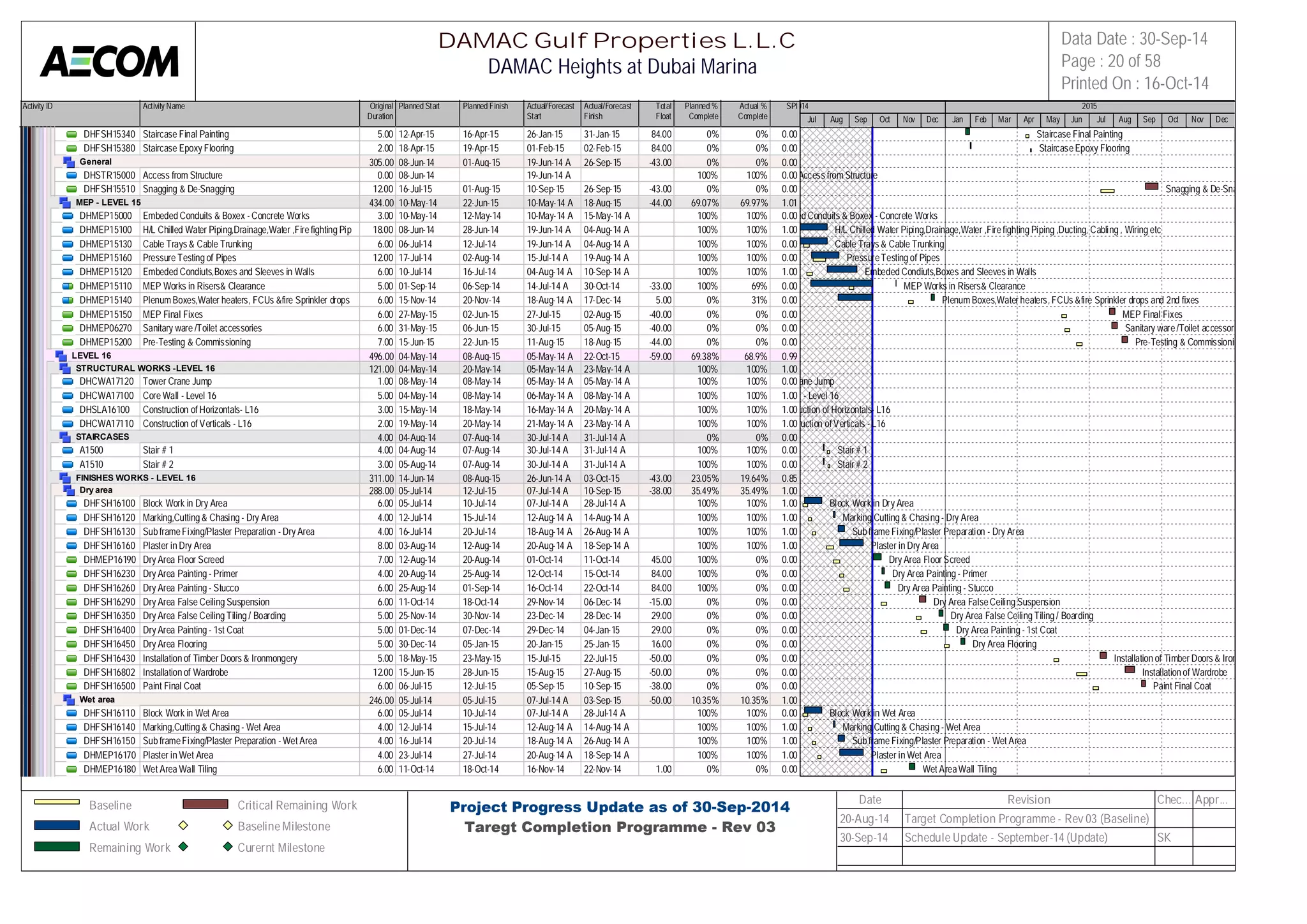

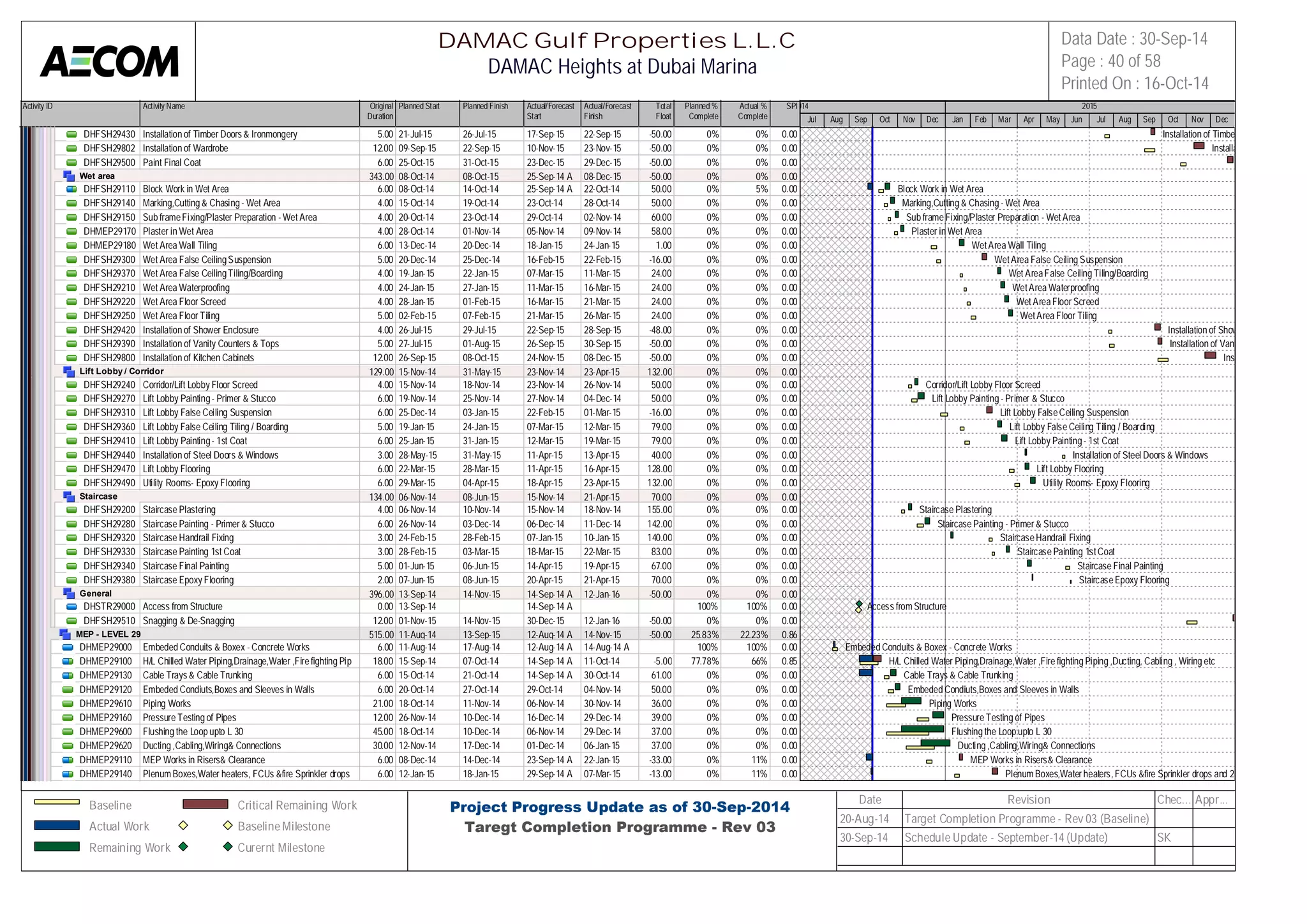

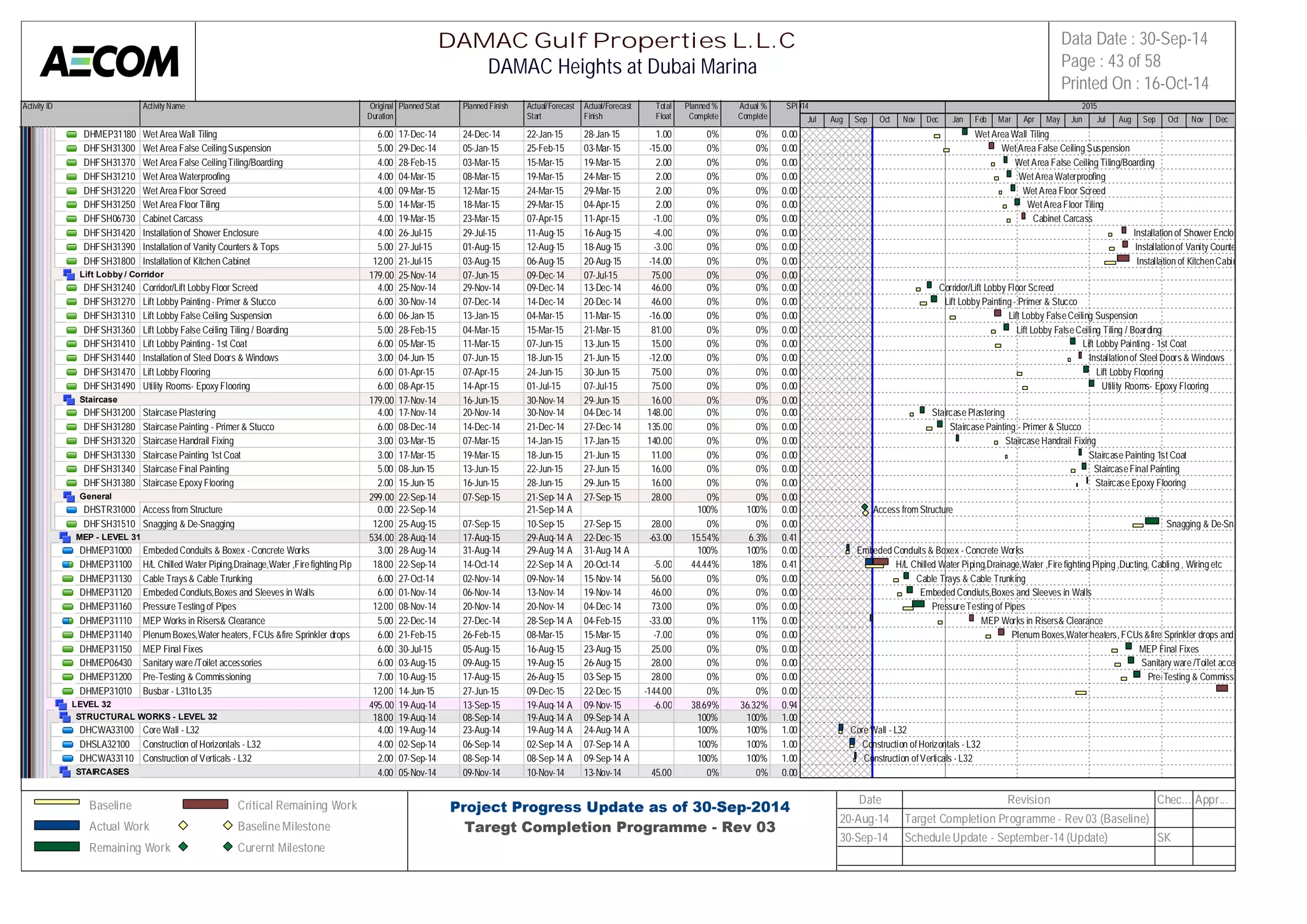

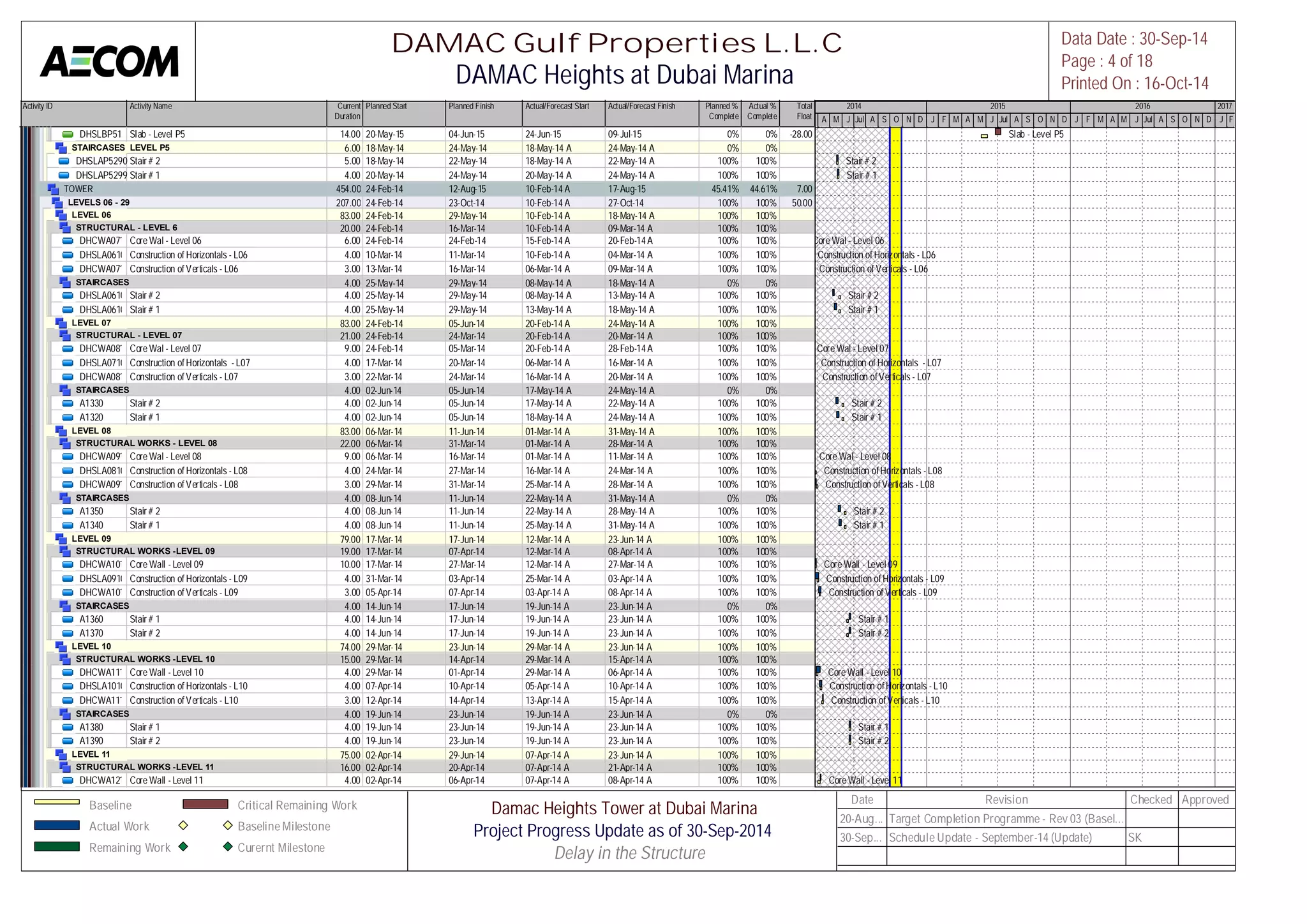

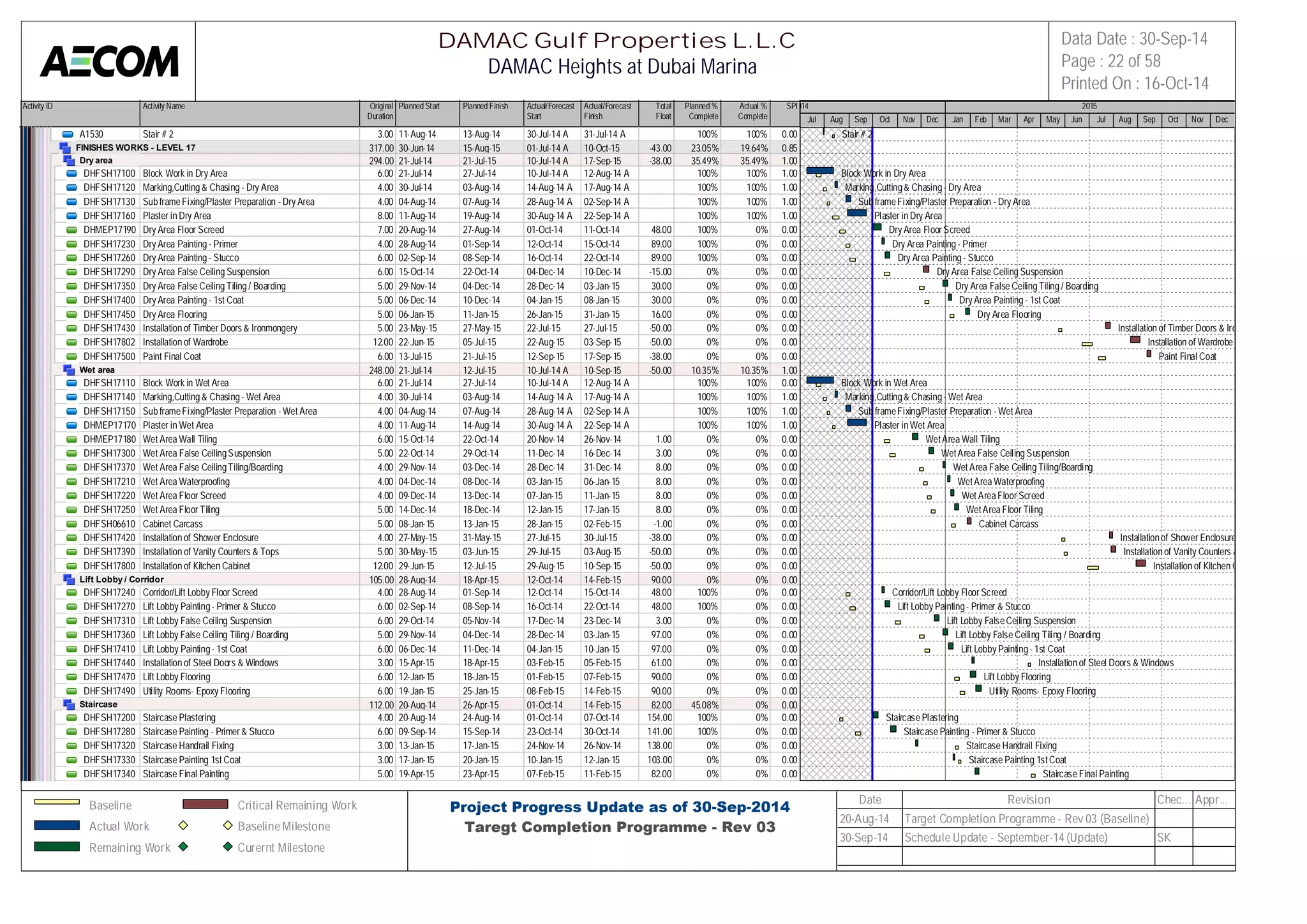

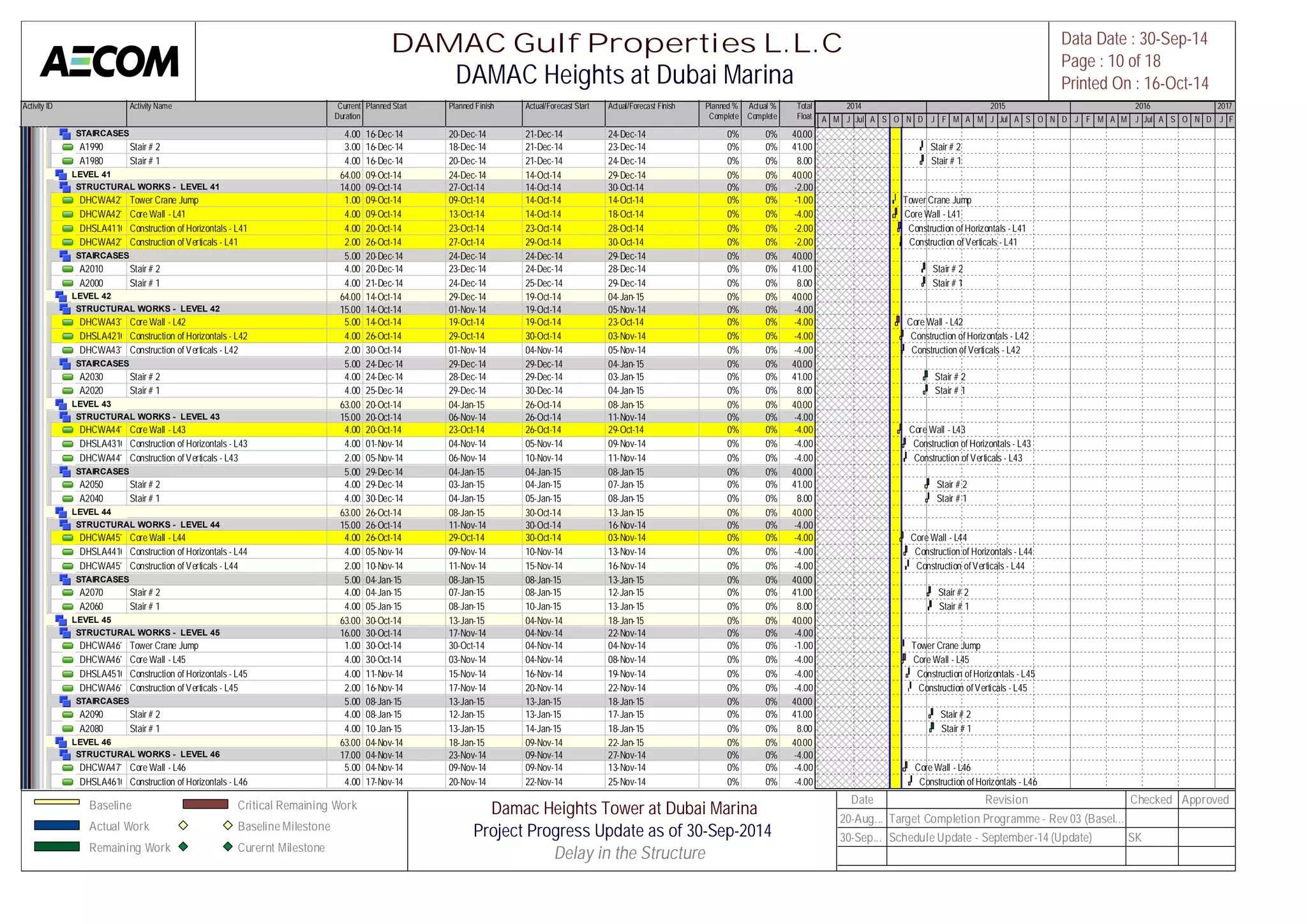

Appendix 1: Schedule Update (Target Completion Programme-Rev3)
Appendix 2: Structure Delay

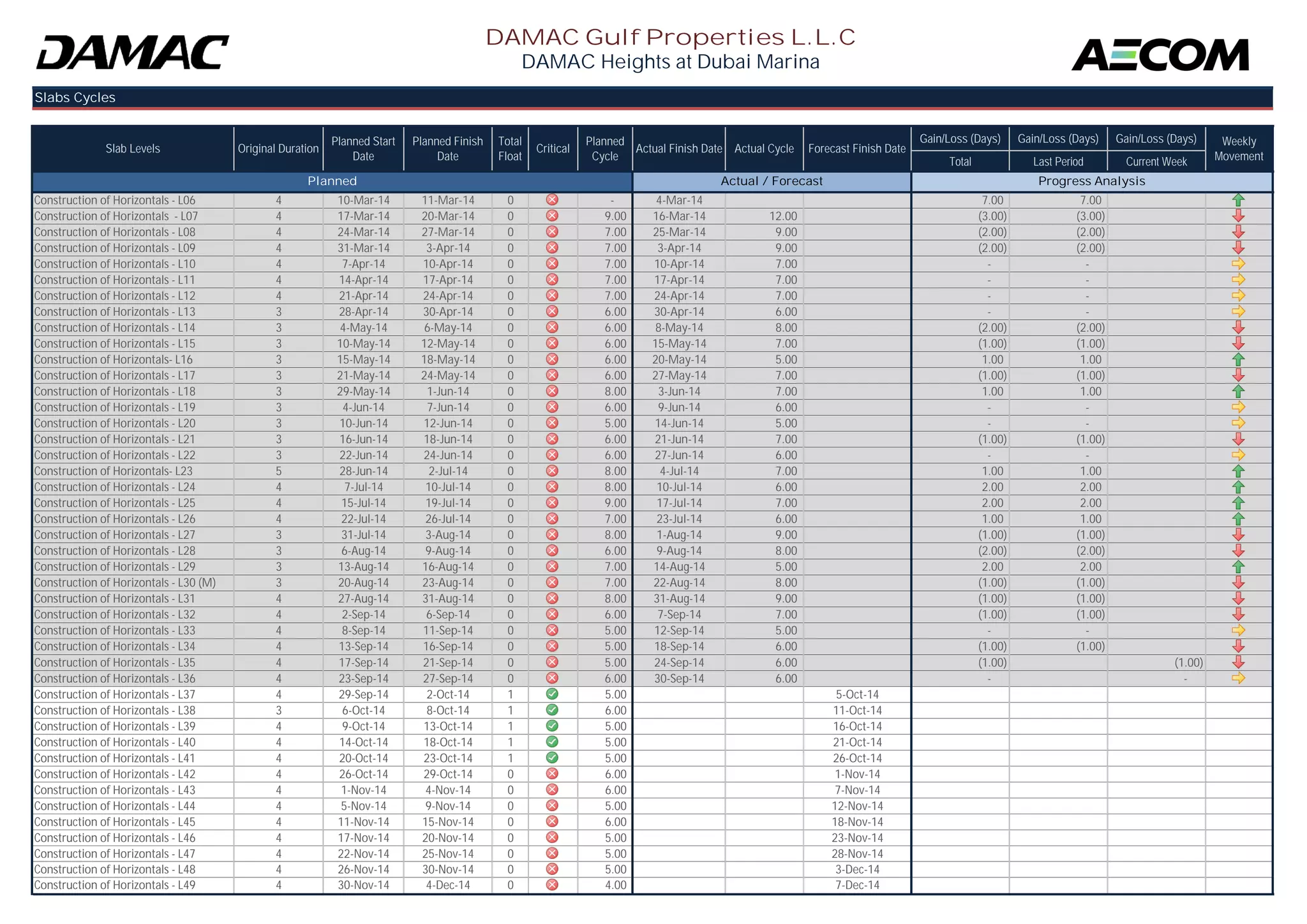

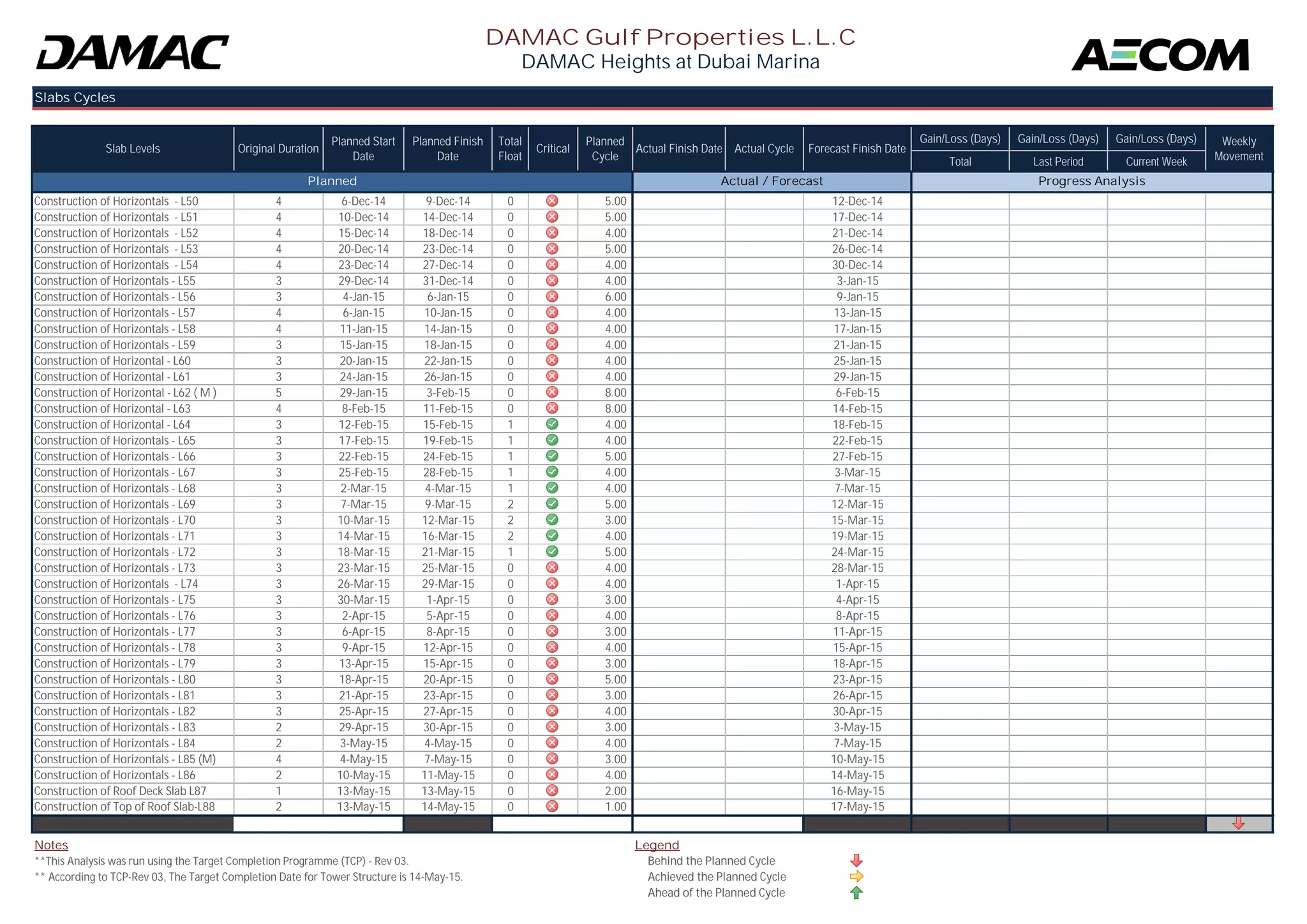

Appendix 3: Core Walls and Slabs Cycles

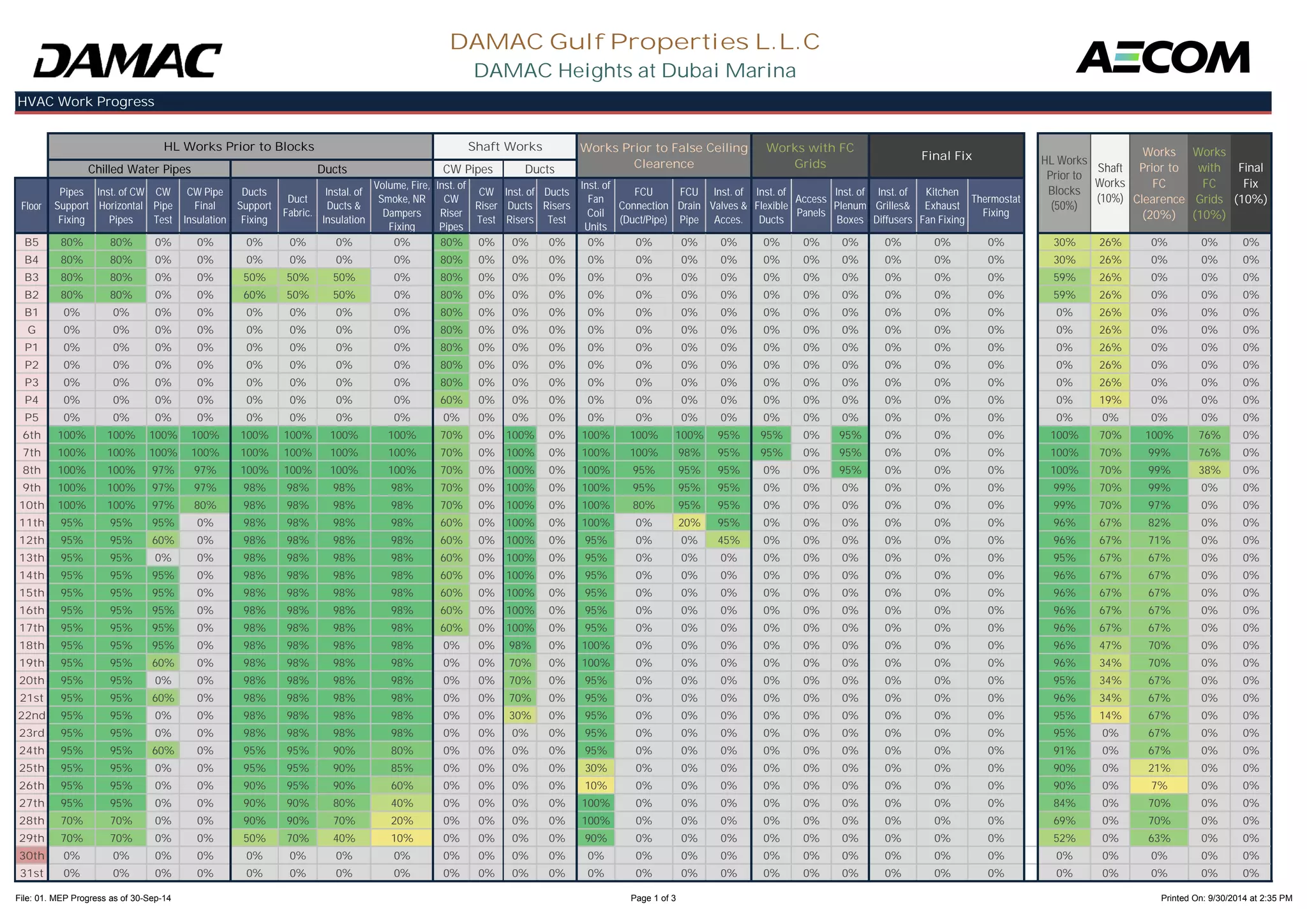

Appendix 4: MEP Progress Data Sheets
Appendix 5: Finishes Progress Data Sheets
Appendix 6: External Facade Progress Data Sheets
Appendix 7: Lifts Progress Data Sheets
Appendix 8: Garbage Chute Progress Data Sheets
Appendix 9: Long Lead Items Log
Appendix 10: Provisional Sum Nomination Log

Appendix 11: Building Permit Status
Appendix 12: Technical Review Log

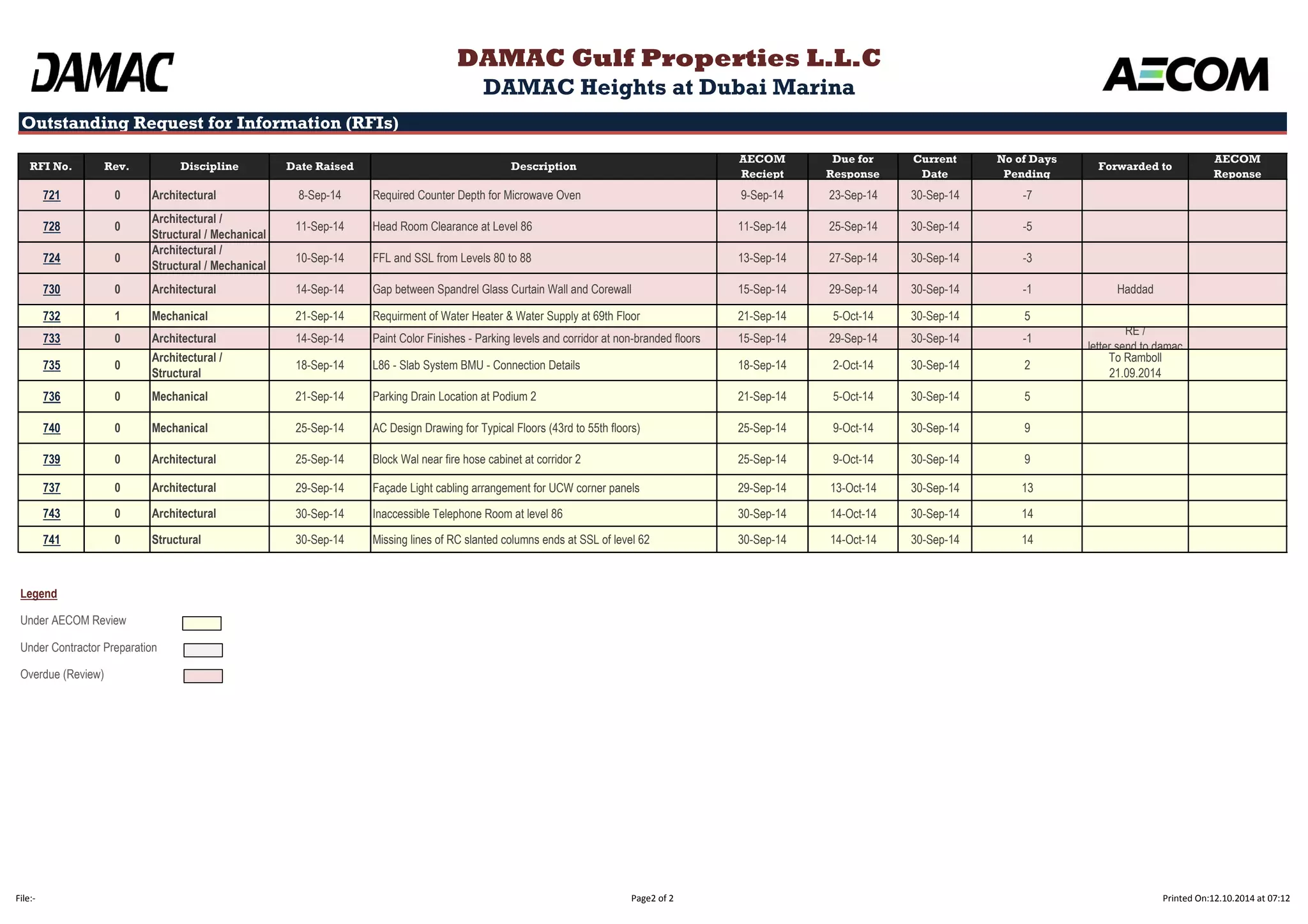

Appendix 13: Outstanding RFIs

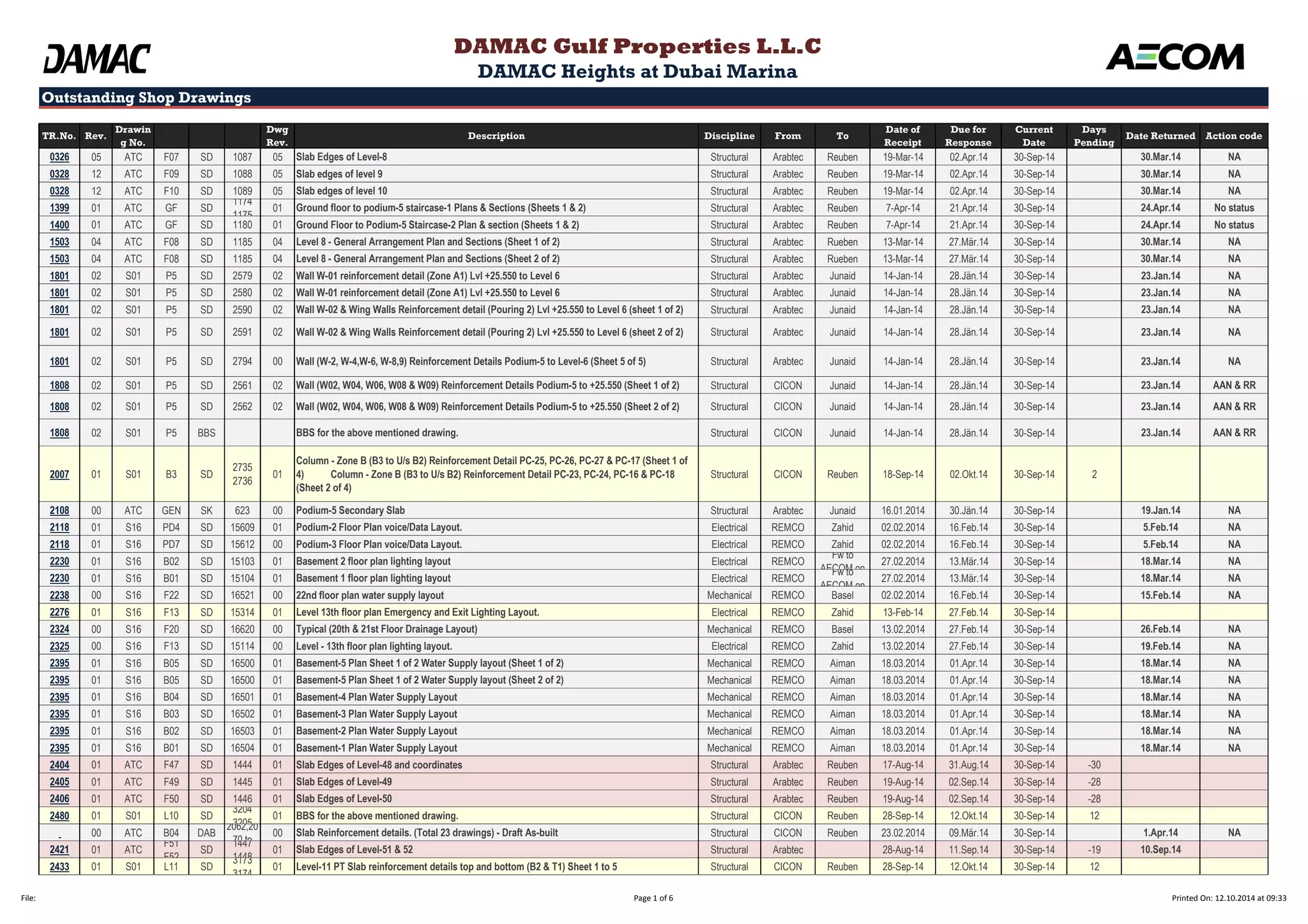

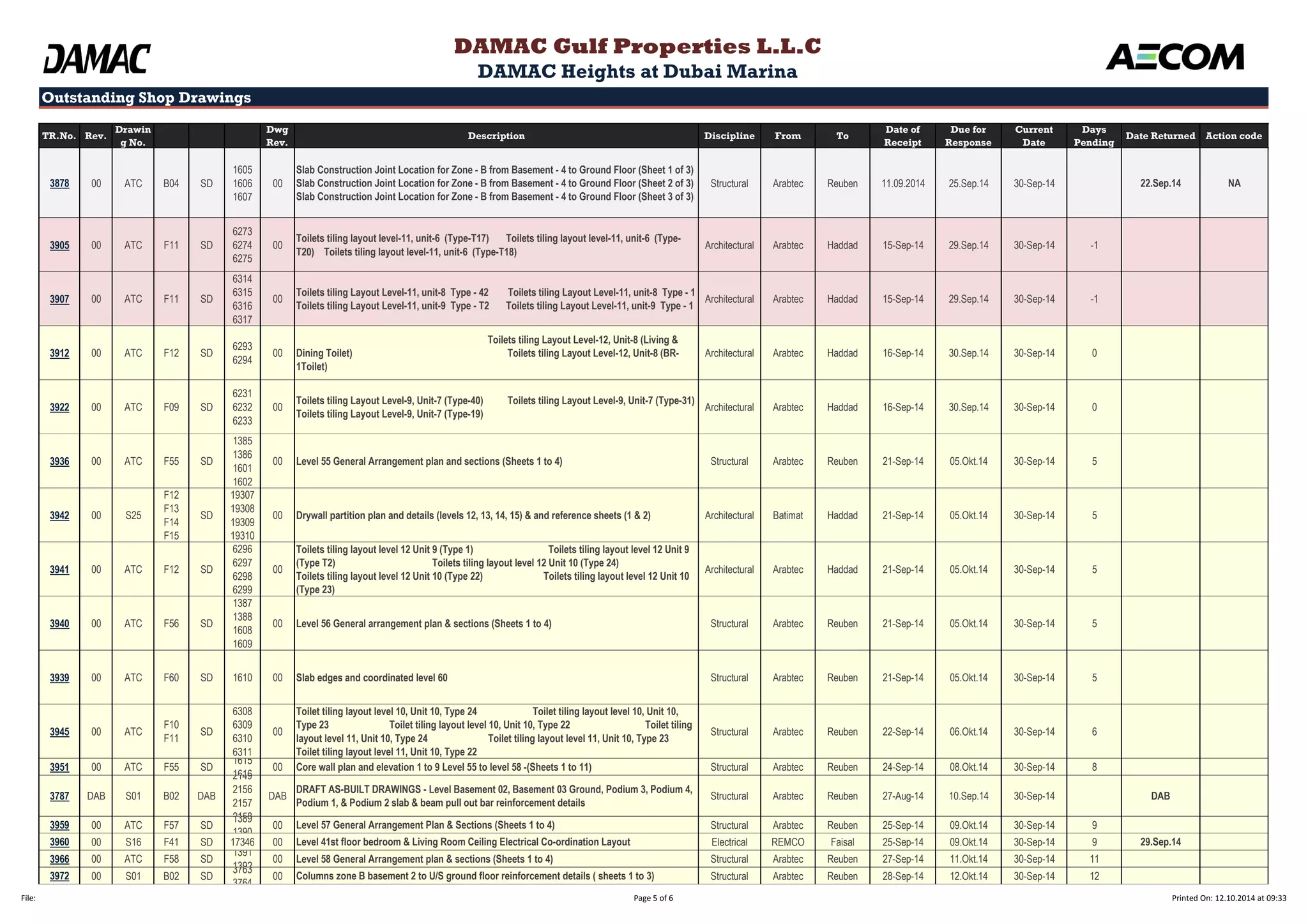

Appendix 14: Outstanding Shop Drawings

Appendix 15: Outstanding Material Submittal

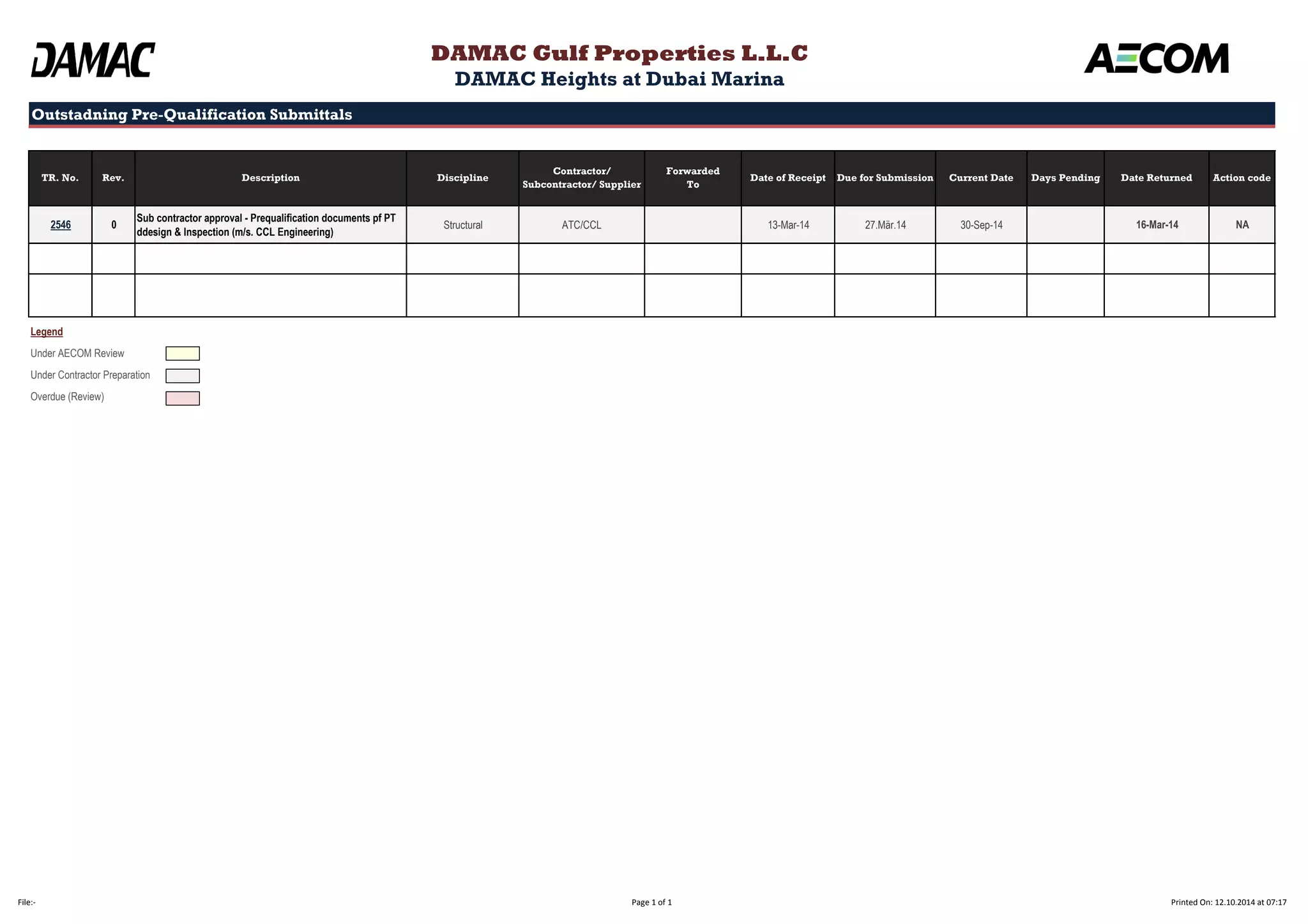

Appendix 16: Outstanding Subcontractors' Prequalification
Appendix 17: Outstanding Method Statement

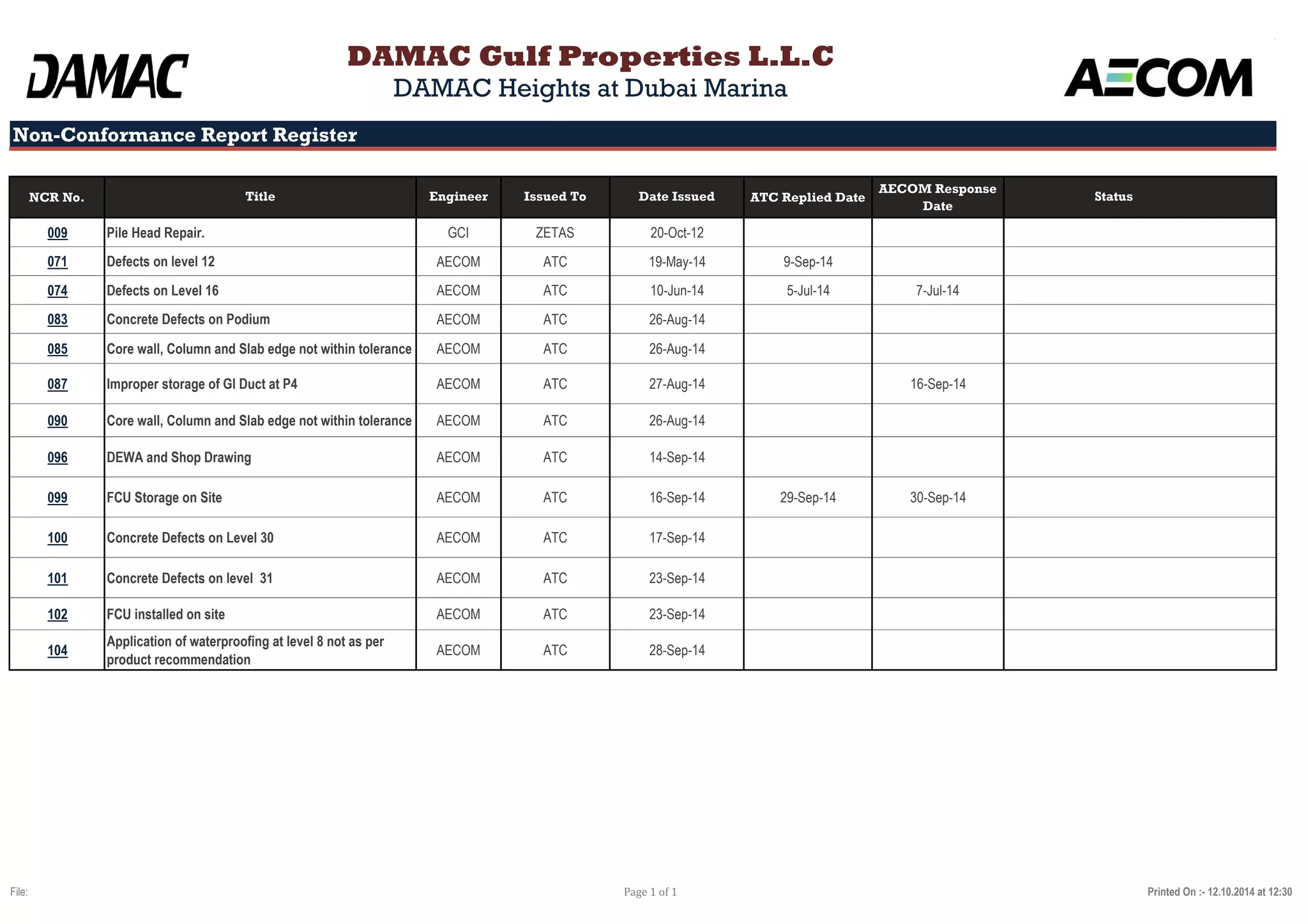

Appendix 18: Non-Conformance Report
Appendix 19: Actions Log

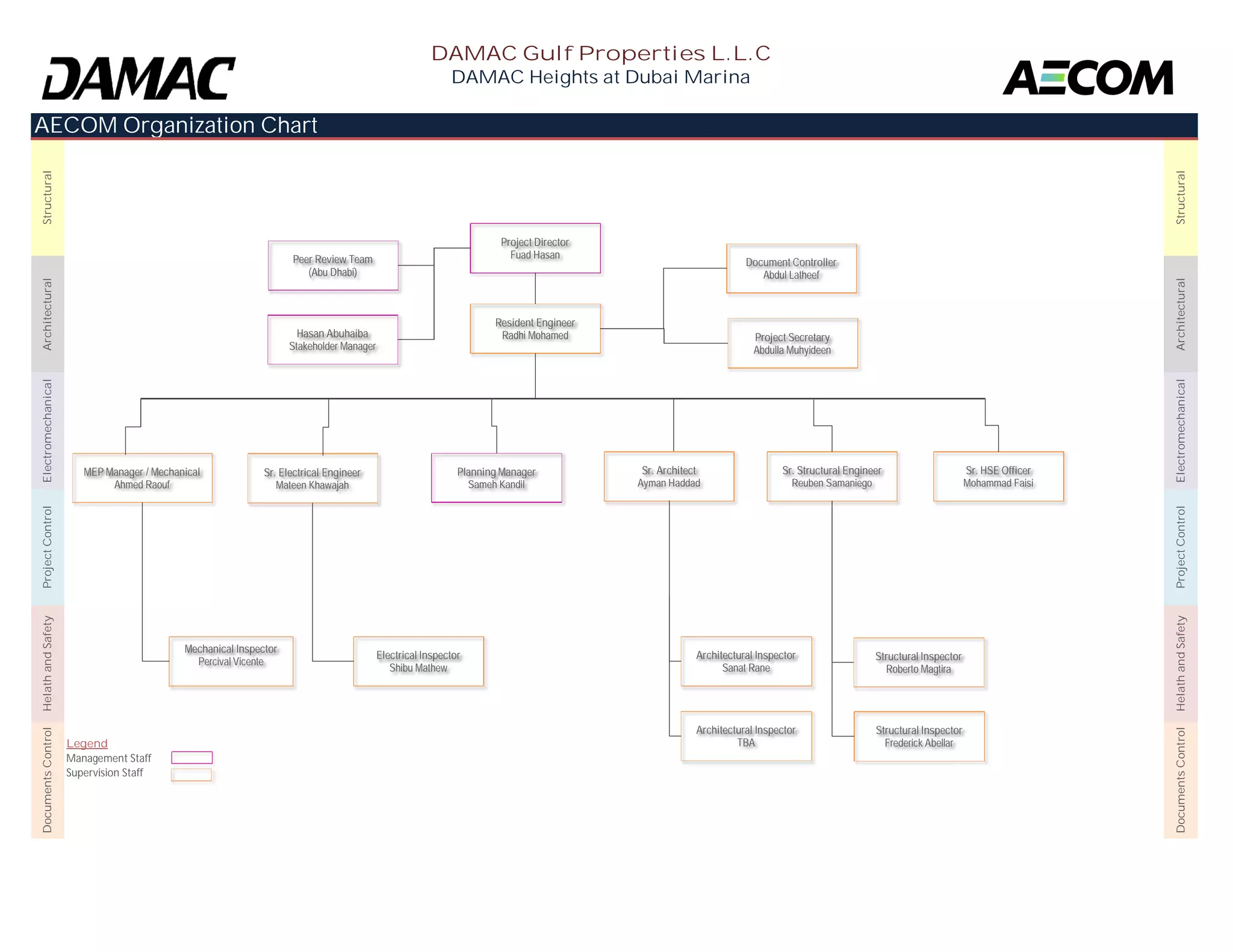

Appendix 20: AECOM's Organization Chart
3
Monthly Progress Report No. 7 - September 2014
Project
Description
4

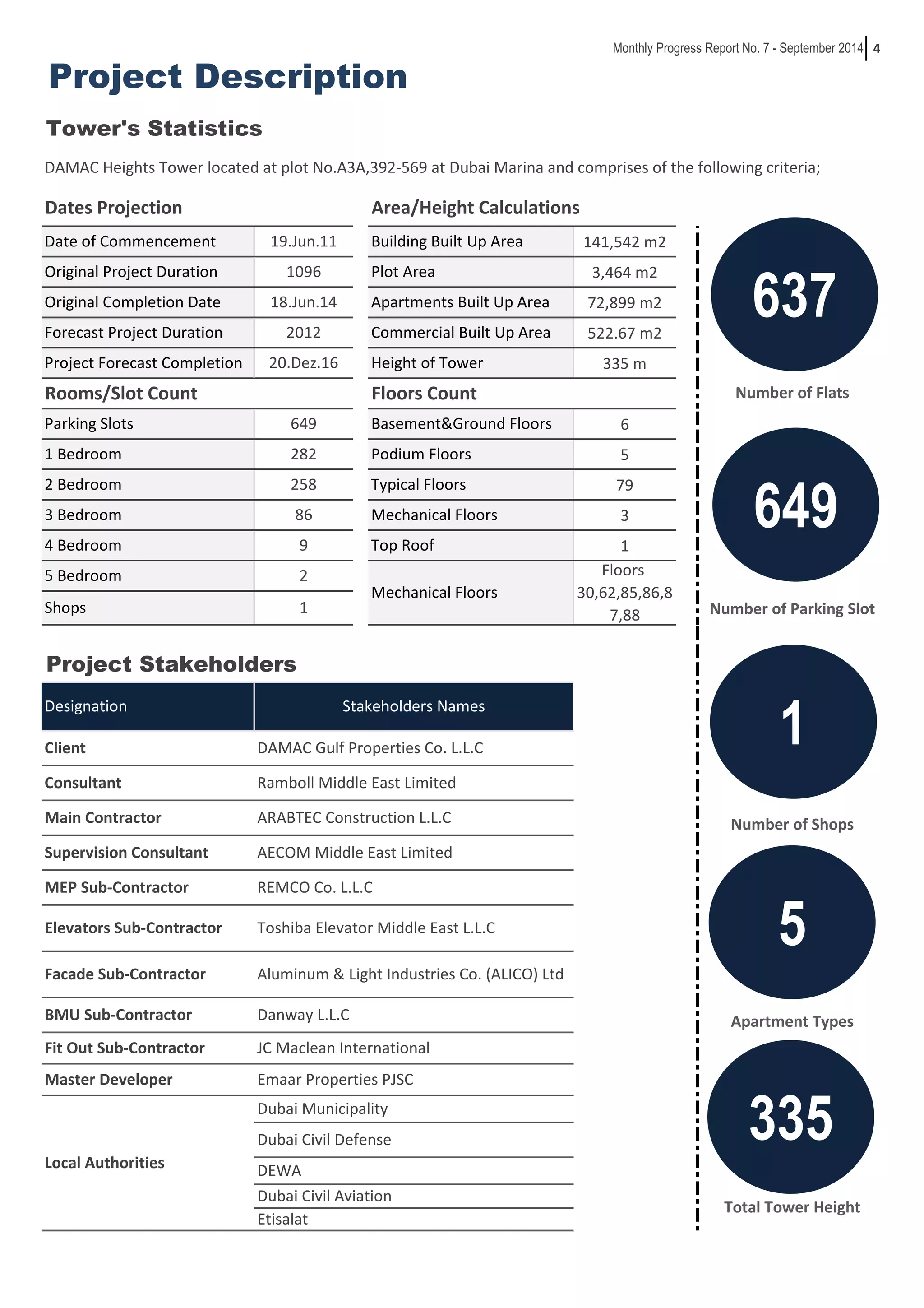

Project Description
Tower's Statistics
DAMAC Heights Tower located at plot No.A3A,392-569 at Dubai Marina and comprises of the following criteria;
141,542 m2
3,464 m2
72,899 m2
522.67 m2
335 m
6
5
79
3
1
Dates Projection
Date of Commencement 19.Jun.11
Original Project Duration 1096
Original Completion Date 18.Jun.14
Forecast Project Duration 2012
Project Forecast Completion 20.Dez.16
2 Bedroom 258
3 Bedroom 86
4 Bedroom 9
5 Bedroom 2
Shops
Project Stakeholders
Monthly Progress Report No. 7 - September 2014
Designation
1
Main Contractor
Supervision Consultant
MEP Sub-Contractor
Facade Sub-Contractor
Building Built Up Area
Plot Area
Apartments Built Up Area
Commercial Built Up Area
Stakeholders Names
Ramboll Middle East Limited
ARABTEC Construction L.L.C
AECOM Middle East Limited
REMCO Co. L.L.C
Elevators Sub-Contractor
Master Developer
Local Authorities
DAMAC Gulf Properties Co. L.L.C
Toshiba Elevator Middle East L.L.C
Aluminum & Light Industries Co. (ALICO) Ltd
Emaar Properties PJSC
Dubai Municipality
Client
Consultant
BMU Sub-Contractor
Danway L.L.C
Fit Out Sub-Contractor JC Maclean International
Dubai Civil Defense
DEWA
Dubai Civil Aviation
Etisalat
Number of Flats
Number of Parking Slot
Number of Shops
Total Tower Height
Top Roof
Mechanical Floors
Floors
30,62,85,86,8
7,88
Area/Height Calculations
Height of Tower
Floors Count
Basement&Ground Floors
Podium Floors
Typical Floors
Mechanical Floors
Apartment Types
Rooms/Slot Count
Parking Slots 649
1 Bedroom 282
637
649
1
5
335
5
Monthly Progress Report No. 7 - September 2014
Executive
Summary
6

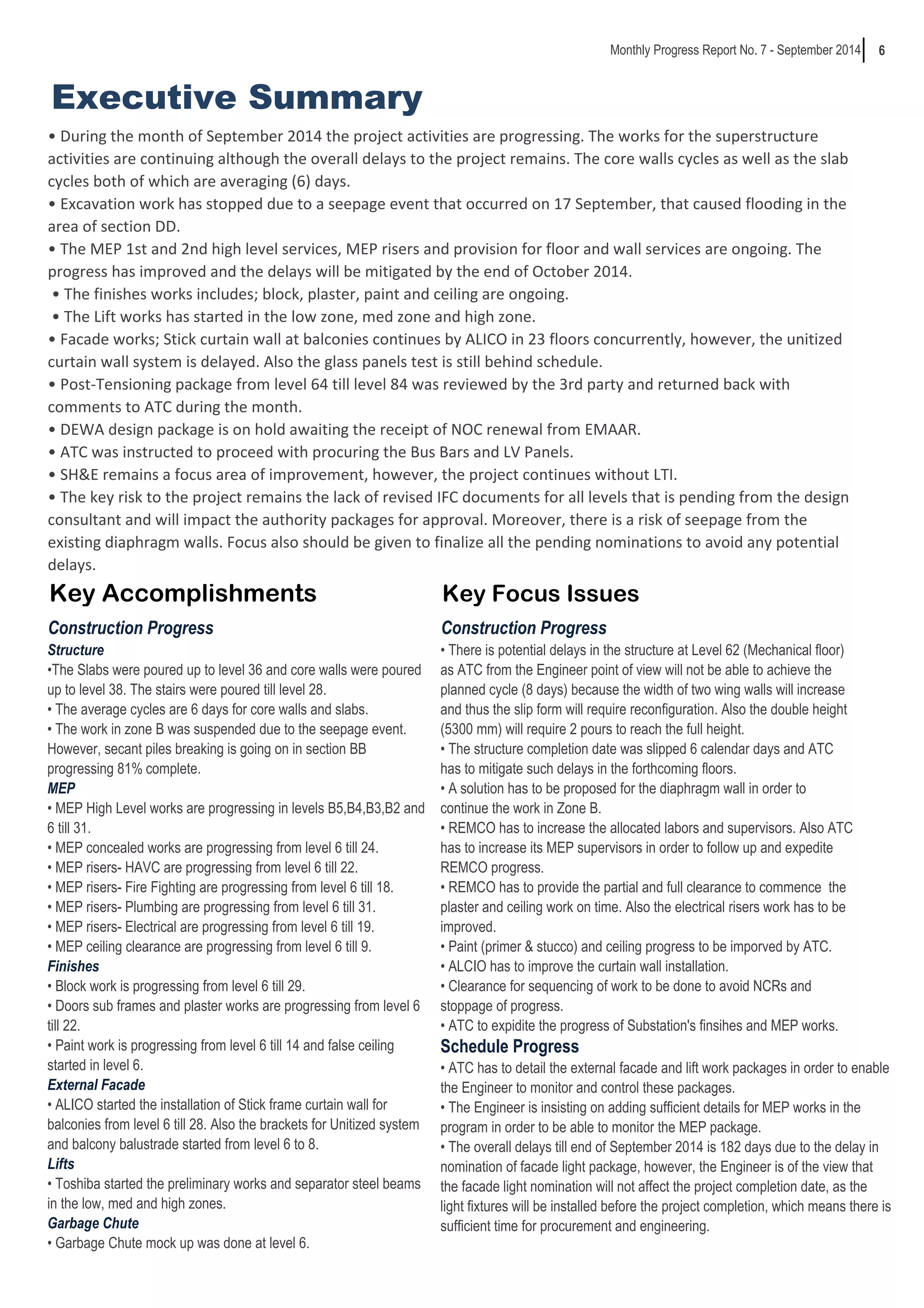

Executive Summary
Monthly Progress Report No. 7 - September 2014
• DuriŶg the ŵoŶth of Septeŵďer ϮϬϭϰ the projeĐt aĐtiǀities are progressiŶg. The ǁorks for the superstruĐture
activities are continuing although the overall delays to the project remains. The core walls cycles as well as the slab
cycles both of which are averaging (6) days.
• EdžĐaǀatioŶ ǁork has stopped due to a seepage eǀeŶt that oĐĐurred oŶ ϭϳ Septeŵďer, that Đaused floodiŶg iŶ the
area of section DD.
• The MEP ϭst aŶd ϮŶd high leǀel serǀiĐes, MEP risers aŶd proǀisioŶ for floor aŶd ǁall serǀiĐes are oŶgoiŶg. The
progress has improved and the delays will be mitigated by the end of October 2014.
• The fiŶishes ǁorks iŶĐludes; ďloĐk, plaster, paiŶt aŶd ĐeiliŶg are oŶgoiŶg.
• The Lift ǁorks has started iŶ the loǁ zoŶe, ŵed zoŶe aŶd high zoŶe.
• FaĐade ǁorks; StiĐk ĐurtaiŶ ǁall at ďalĐoŶies ĐoŶtiŶues ďLJ ALICO iŶ Ϯϯ floors ĐoŶĐurreŶtlLJ, hoǁeǀer, the uŶitized
curtain wall system is delayed. Also the glass panels test is still behind schedule.
• Post-TeŶsioŶiŶg paĐkage froŵ leǀel ϲϰ till leǀel ϴϰ ǁas reǀieǁed ďLJ the ϯrd partLJ aŶd returŶed ďaĐk ǁith
comments to ATC during the month.
• DEWA desigŶ paĐkage is oŶ hold aǁaitiŶg the reĐeipt of NOC reŶeǁal froŵ EMAAR.
• ATC ǁas iŶstruĐted to proĐeed ǁith proĐuriŶg the Bus Bars aŶd LV PaŶels.
• SH&E reŵaiŶs a foĐus area of iŵproǀeŵeŶt, hoǁeǀer, the projeĐt ĐoŶtiŶues ǁithout LTI.
• The keLJ risk to the projeĐt reŵaiŶs the laĐk of reǀised IFC doĐuŵeŶts for all leǀels that is peŶdiŶg froŵ the desigŶ
consultant and will impact the authority packages for approval. Moreover, there is a risk of seepage from the
existing diaphragm walls. Focus also should be given to finalize all the pending nominations to avoid any potential
delays.

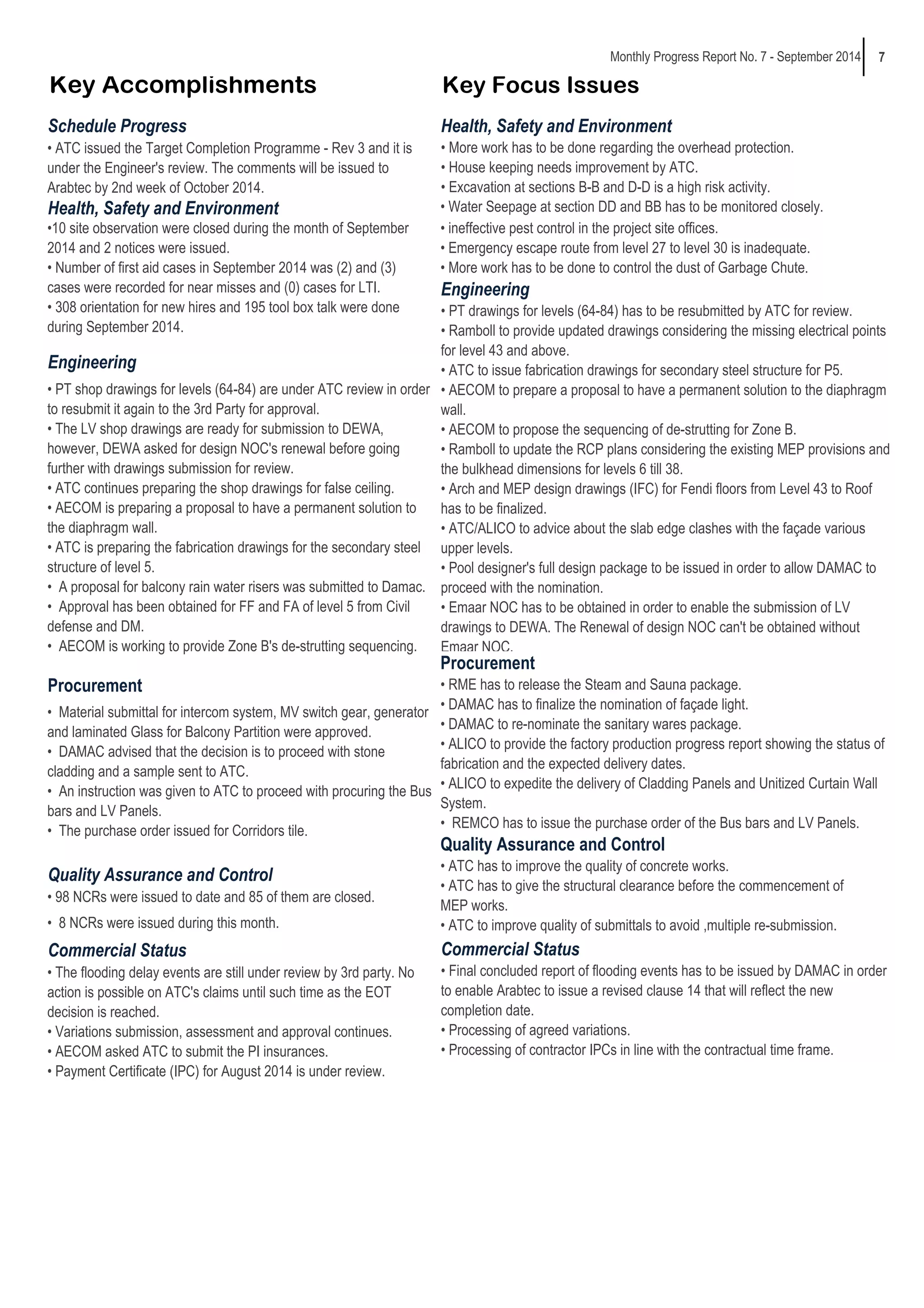

Key Accomplishments Key Focus Issues
Construction Progress Construction Progress
• There is potential delays in the structure at Level 62 (Mechanical floor)
as ATC from the Engineer point of view will not be able to achieve the
planned cycle (8 days) because the width of two wing walls will increase
and thus the slip form will require reconfiguration. Also the double height
(5300 mm) will require 2 pours to reach the full height.
• The structure completion date was slipped 6 calendar days and ATC
has to mitigate such delays in the forthcoming floors.
• A solution has to be proposed for the diaphragm wall in order to
continue the work in Zone B.
• REMCO has to increase the allocated labors and supervisors. Also ATC
has to increase its MEP supervisors in order to follow up and expedite
REMCO progress.
• REMCO has to provide the partial and full clearance to commence the
plaster and ceiling work on time. Also the electrical risers work has to be
improved.
• Paint (primer & stucco) and ceiling progress to be imporved by ATC.
• ALCIO has to improve the curtain wall installation.
• Clearance for sequencing of work to be done to avoid NCRs and
stoppage of progress.
• ATC to expidite the progress of Substation's finsihes and MEP works.

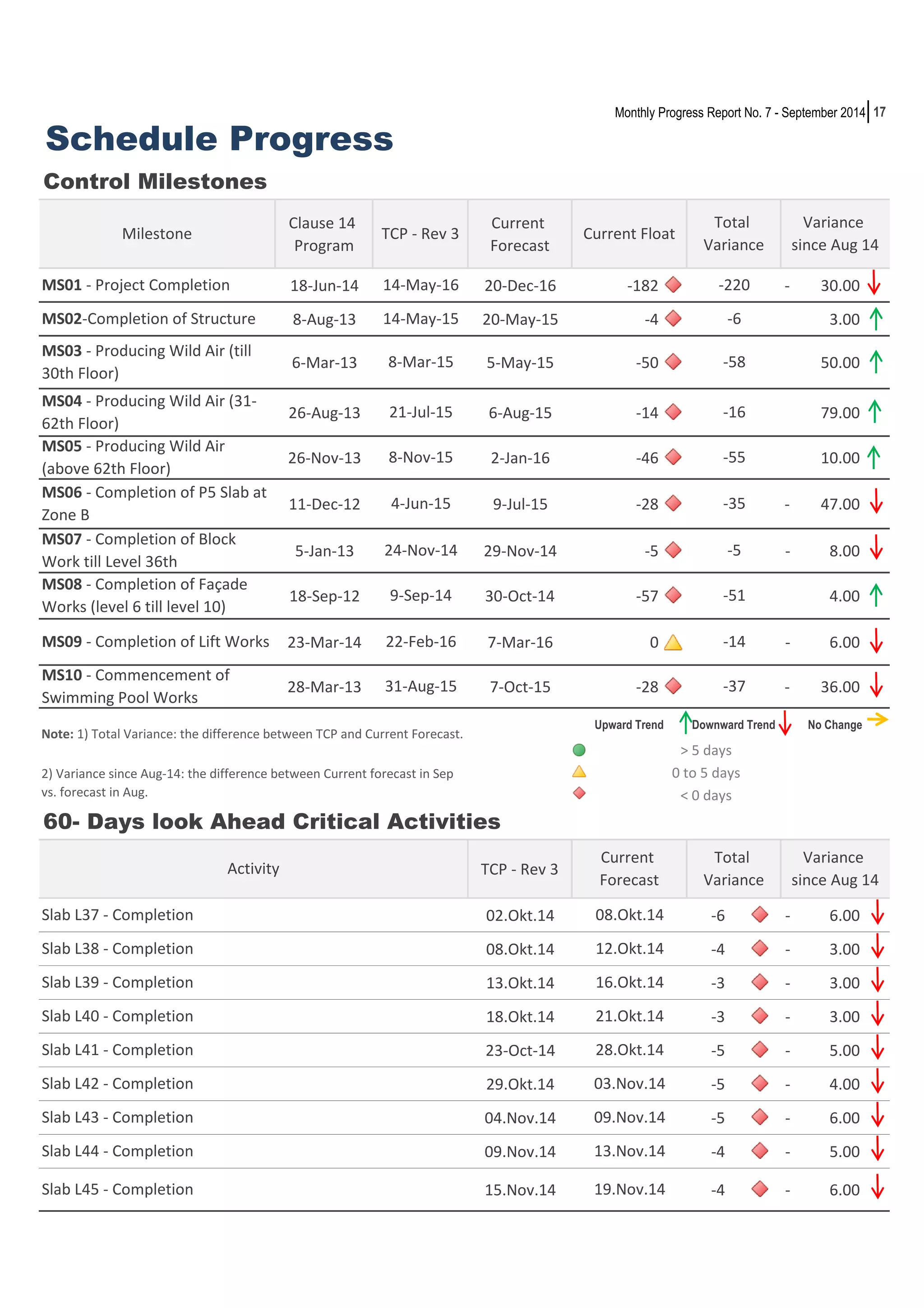

Schedule Progress
• ATC has to detail the external facade and lift work packages in order to enable
the Engineer to monitor and control these packages.
• The Engineer is insisting on adding sufficient details for MEP works in the
program in order to be able to monitor the MEP package.

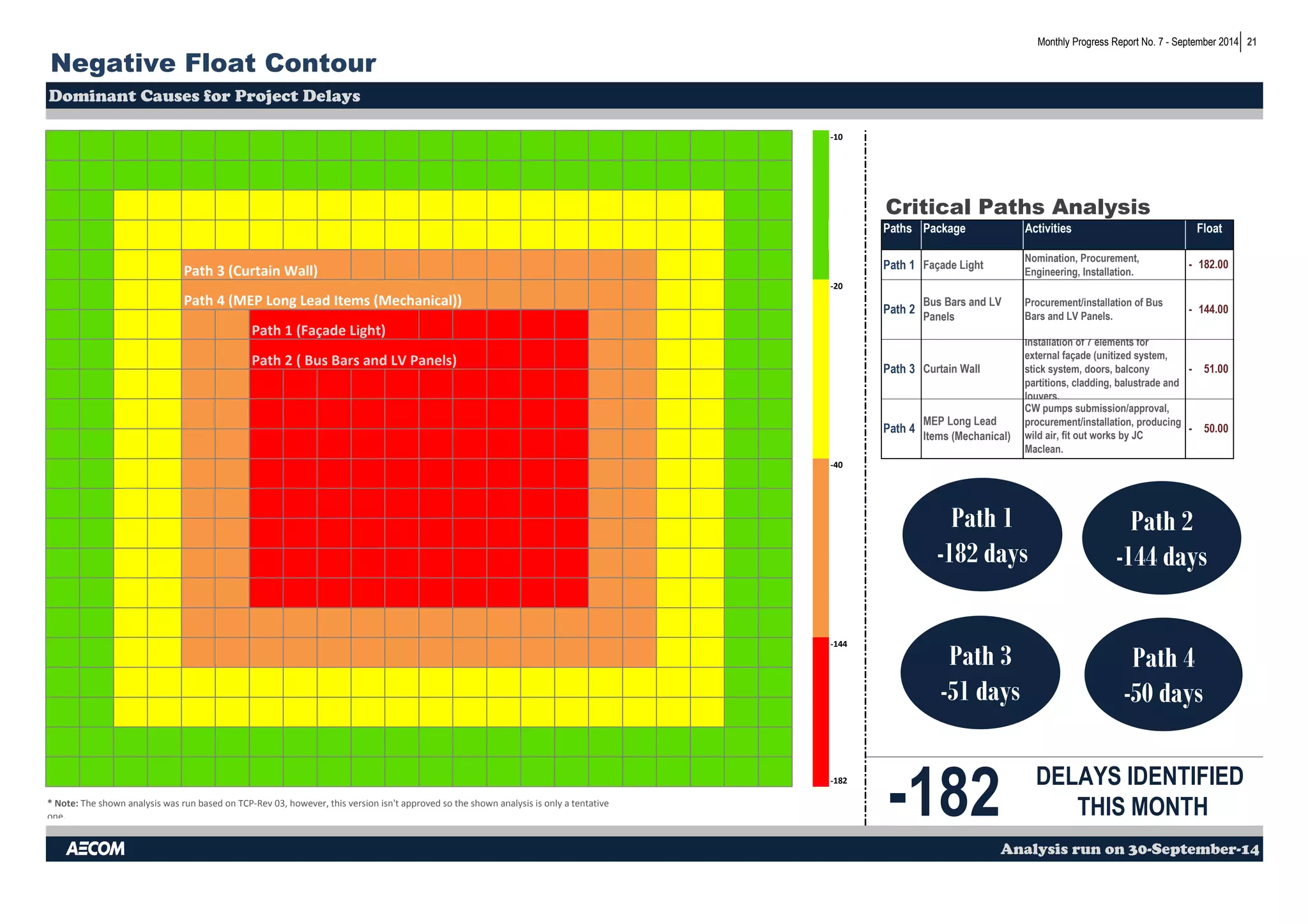

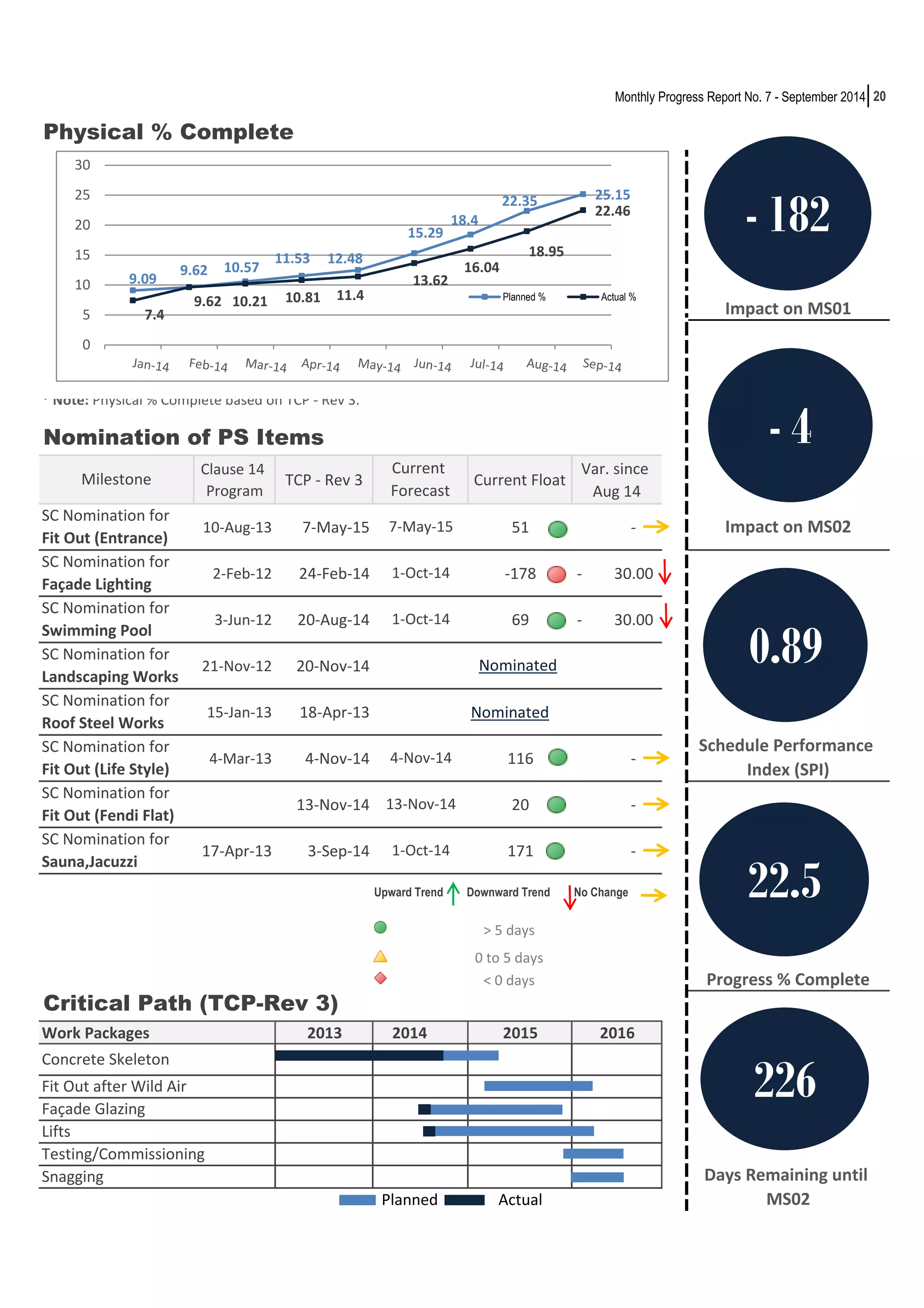

• The overall delays till end of September 2014 is 182 days due to the delay in
nomination of facade light package, however, the Engineer is of the view that
the facade light nomination will not affect the project completion date, as the
light fixtures will be installed before the project completion, which means there is
sufficient time for procurement and engineering.

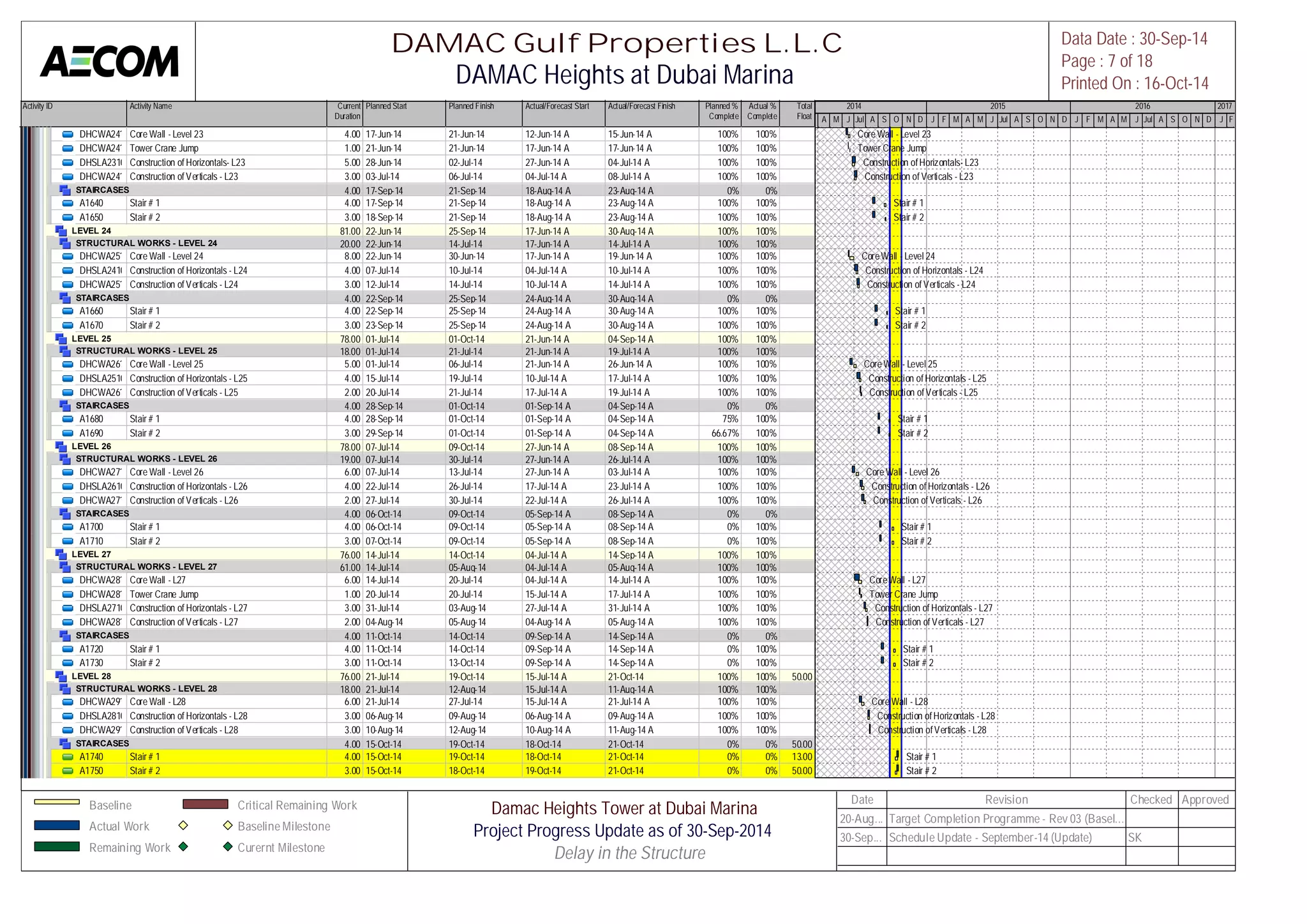

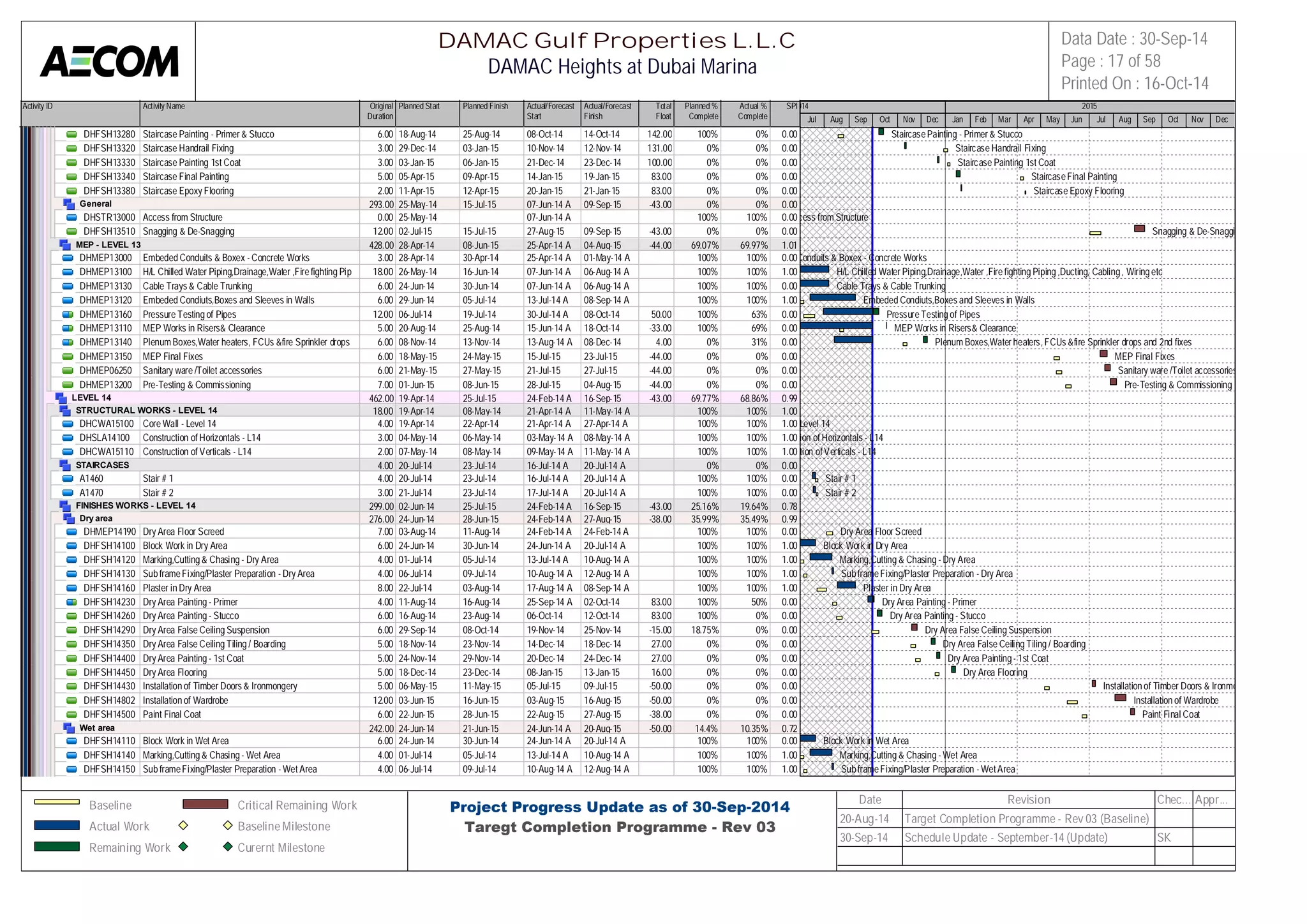

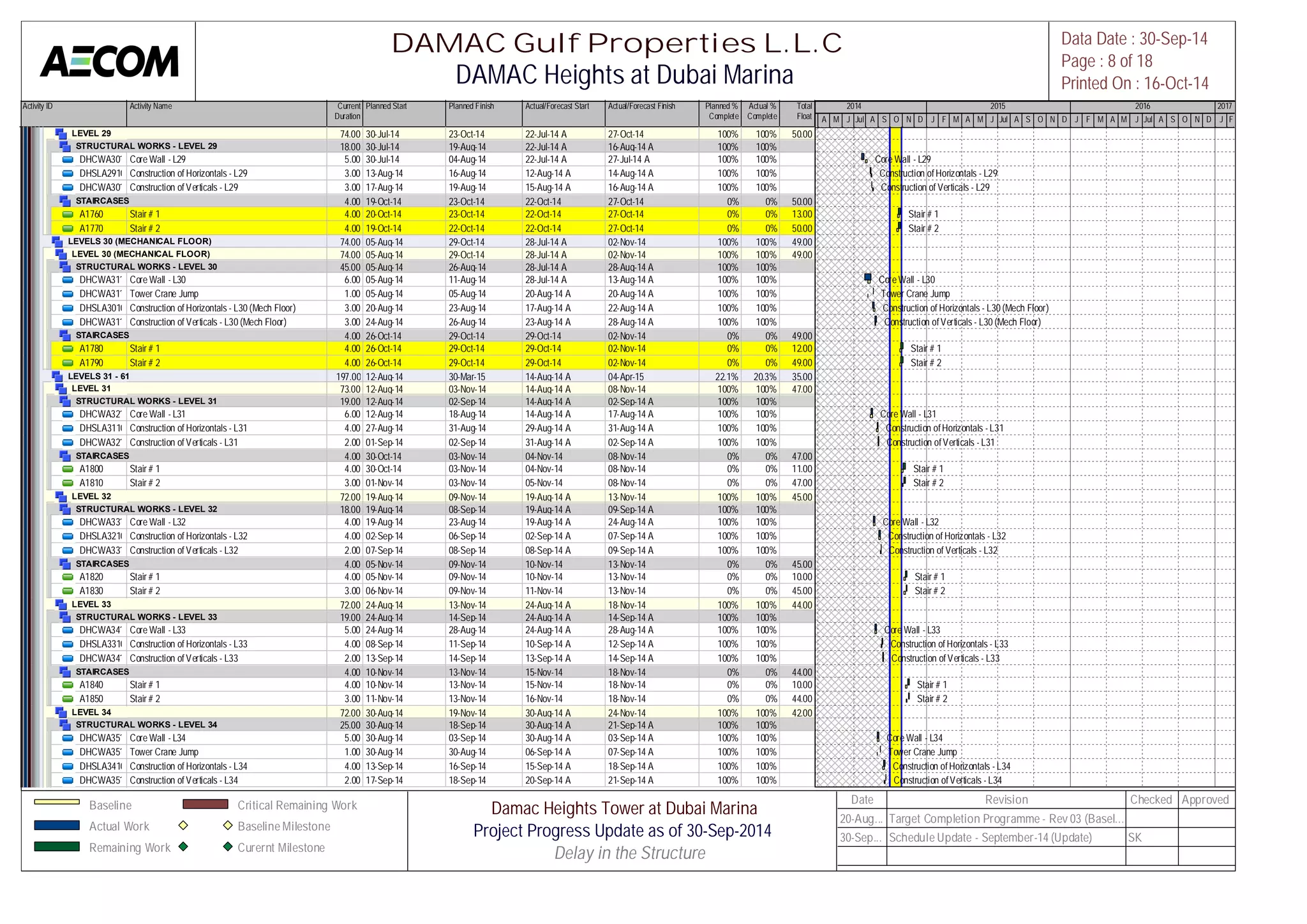

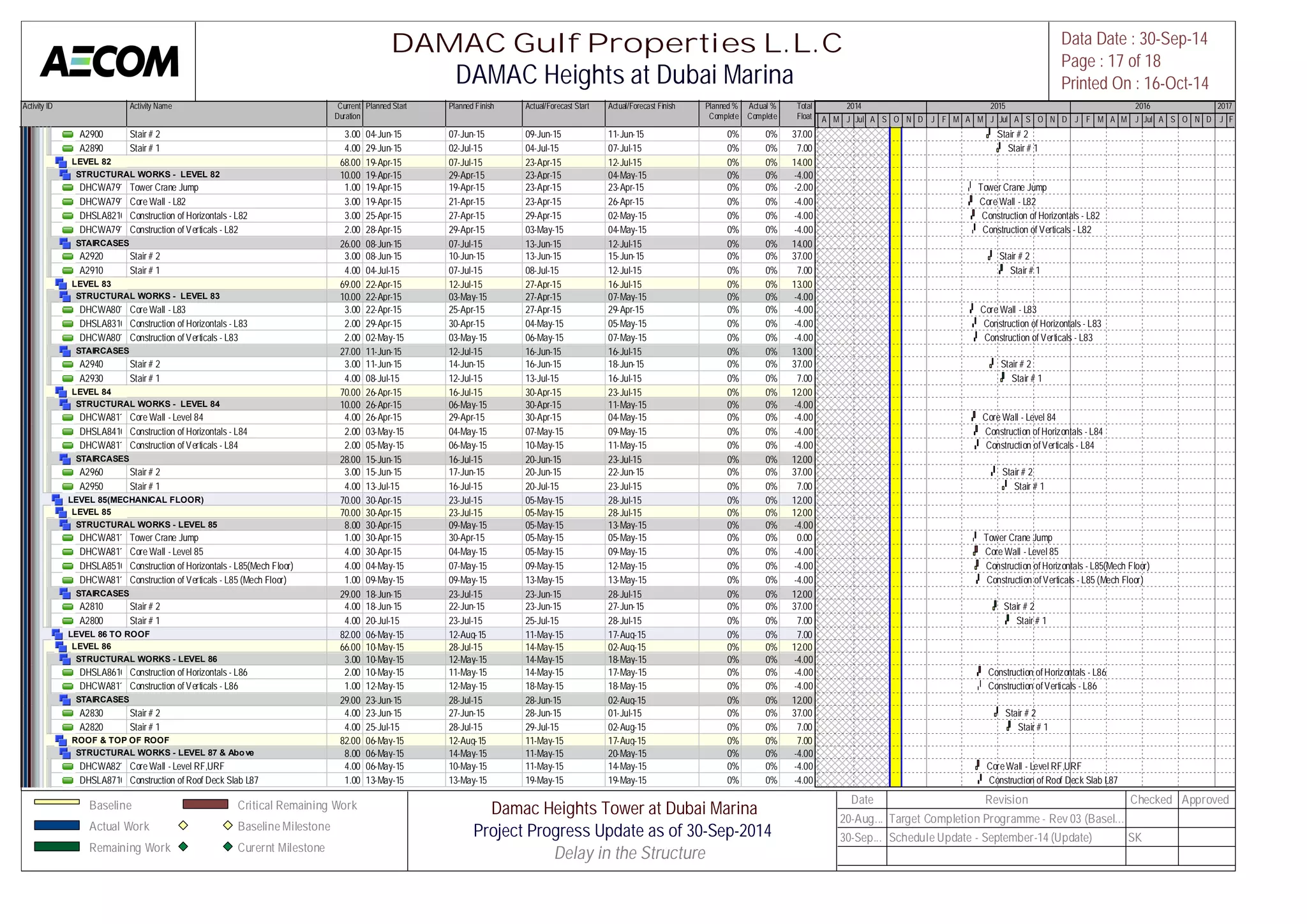

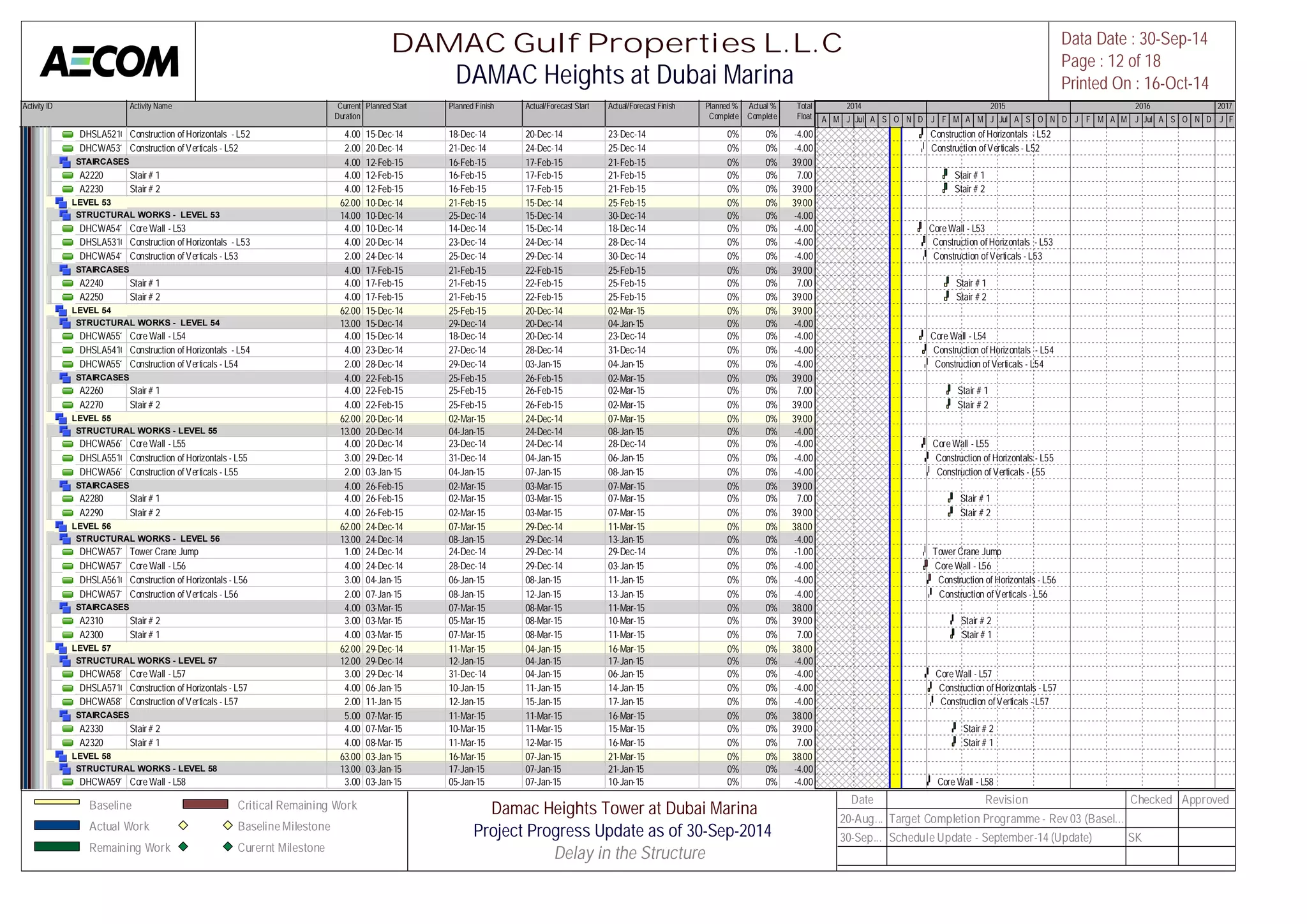

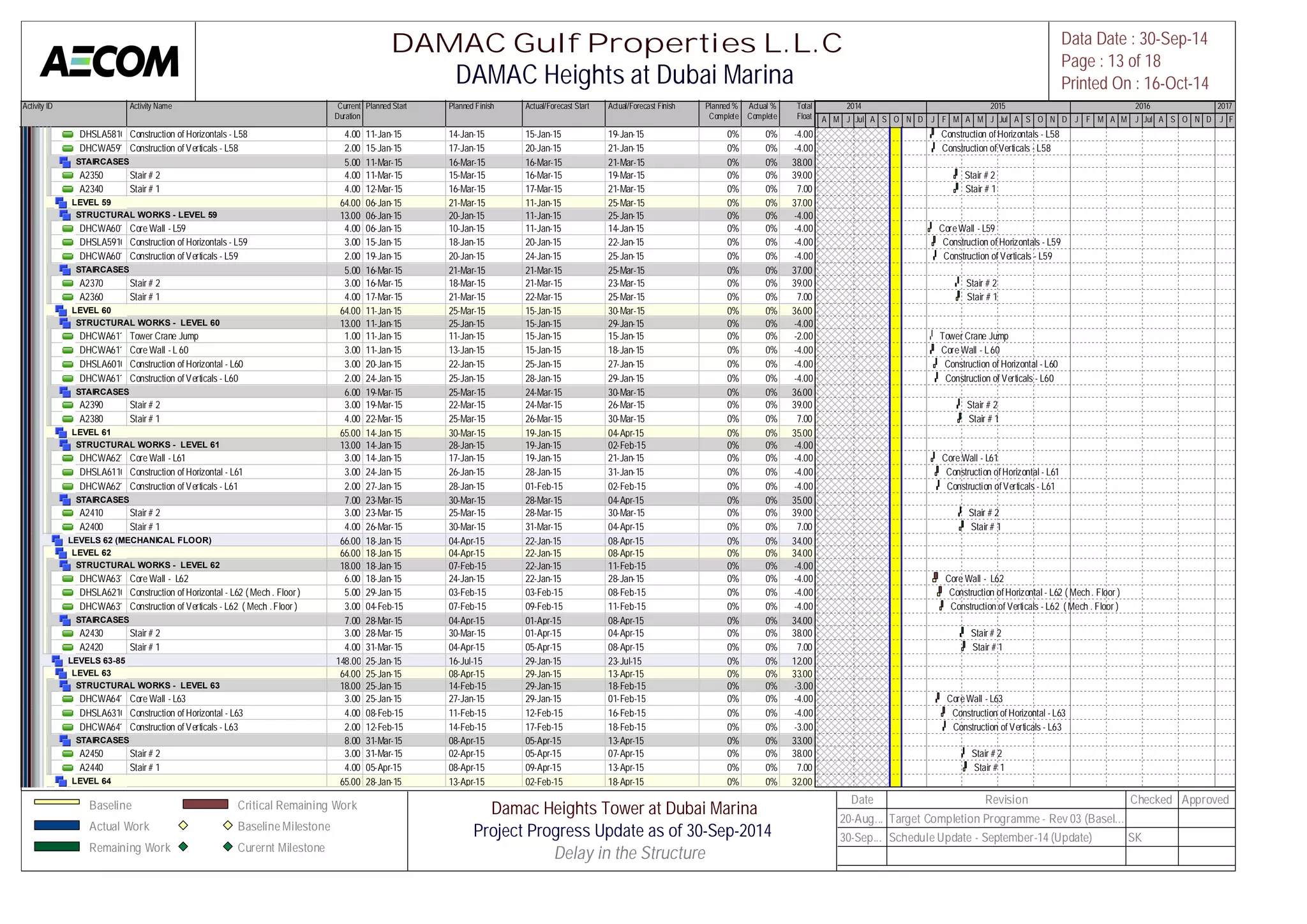

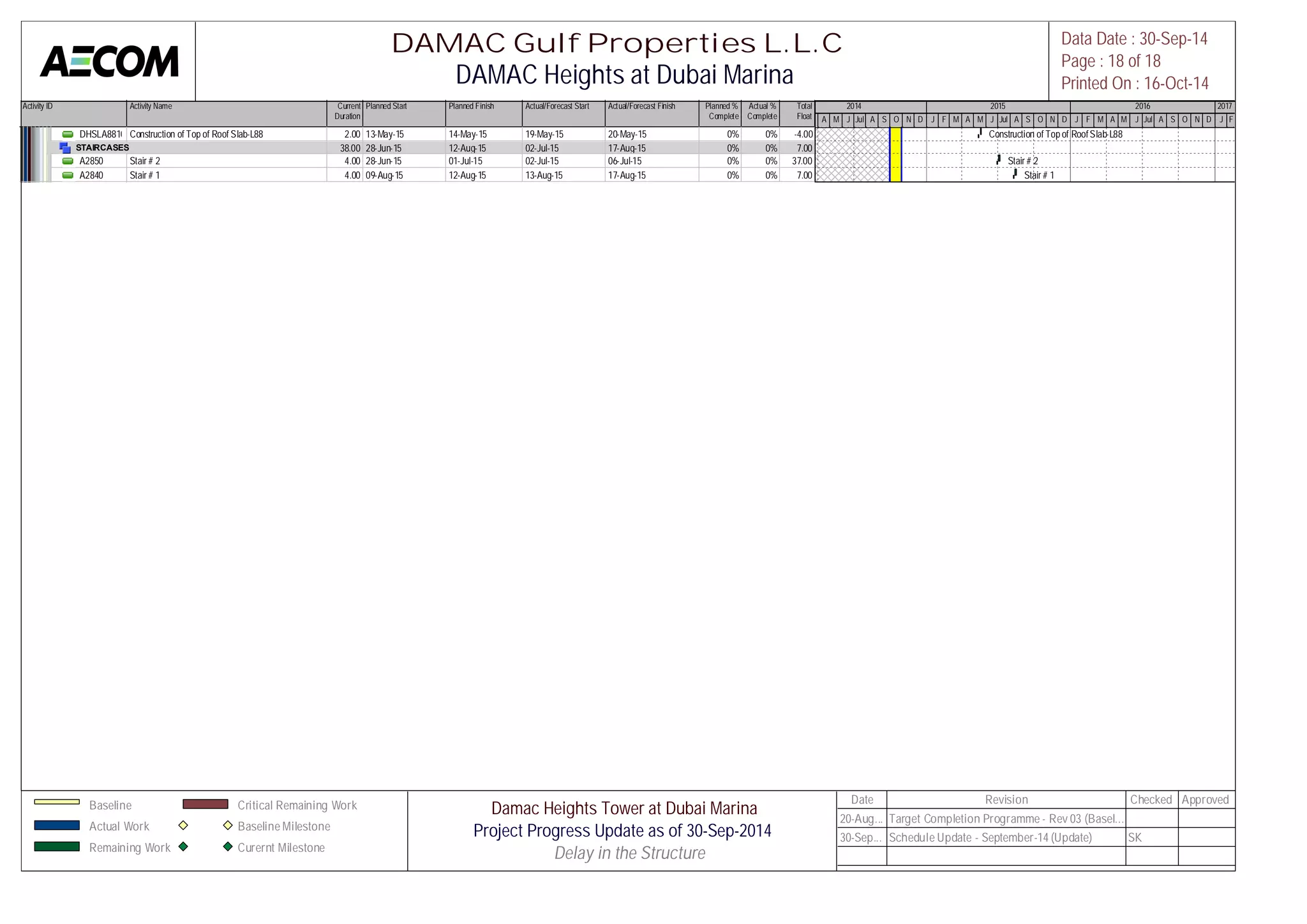

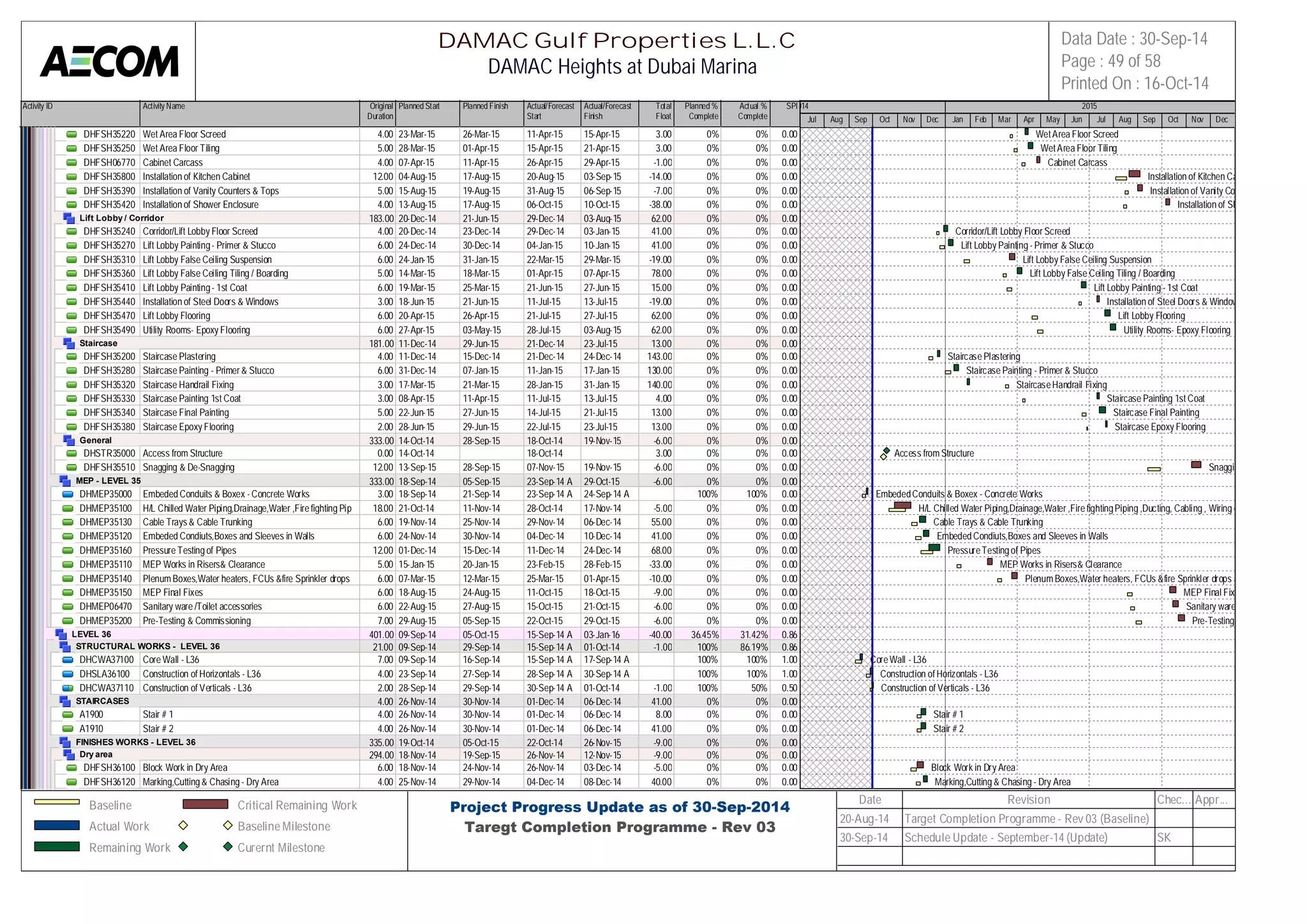

Structure

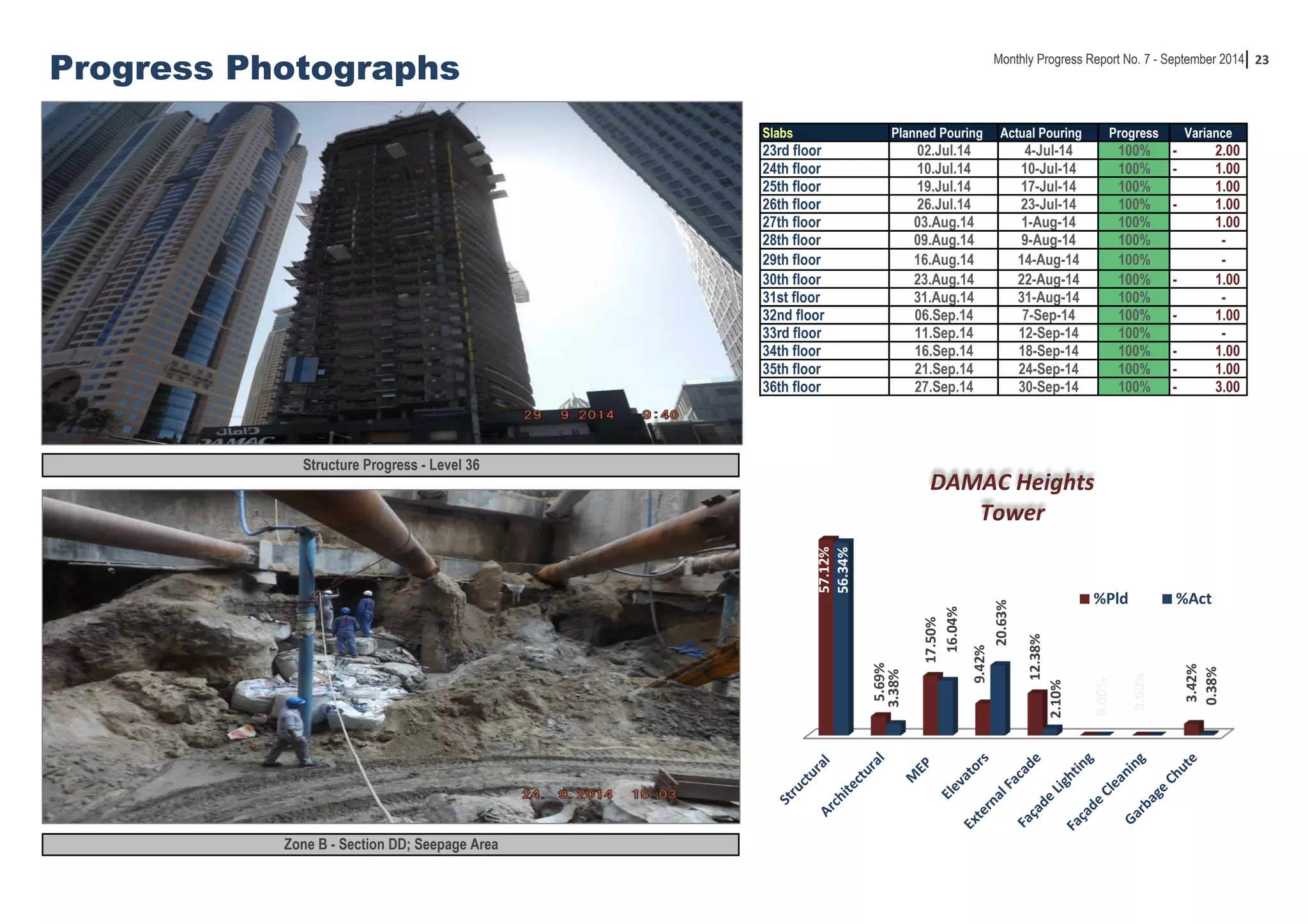

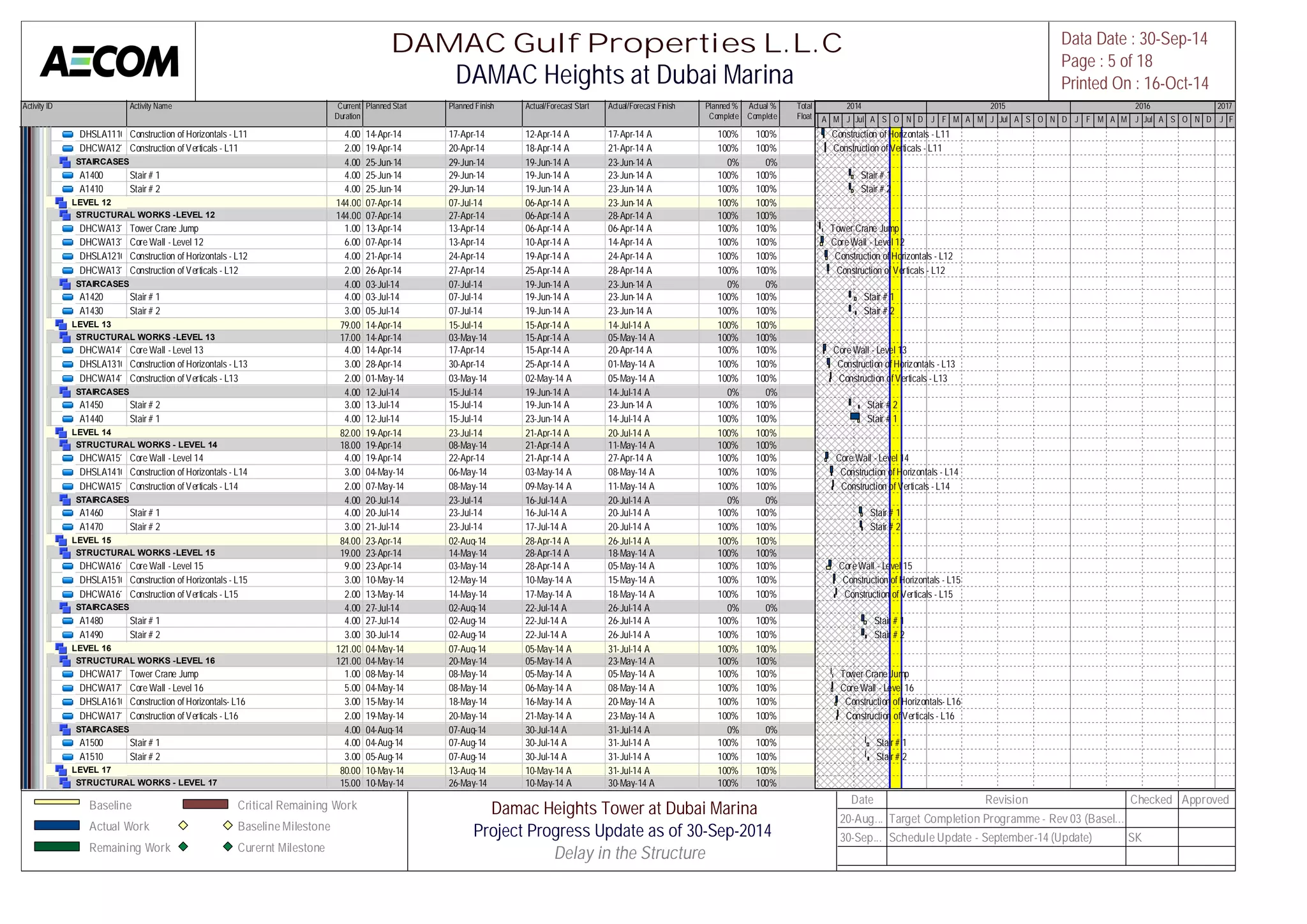

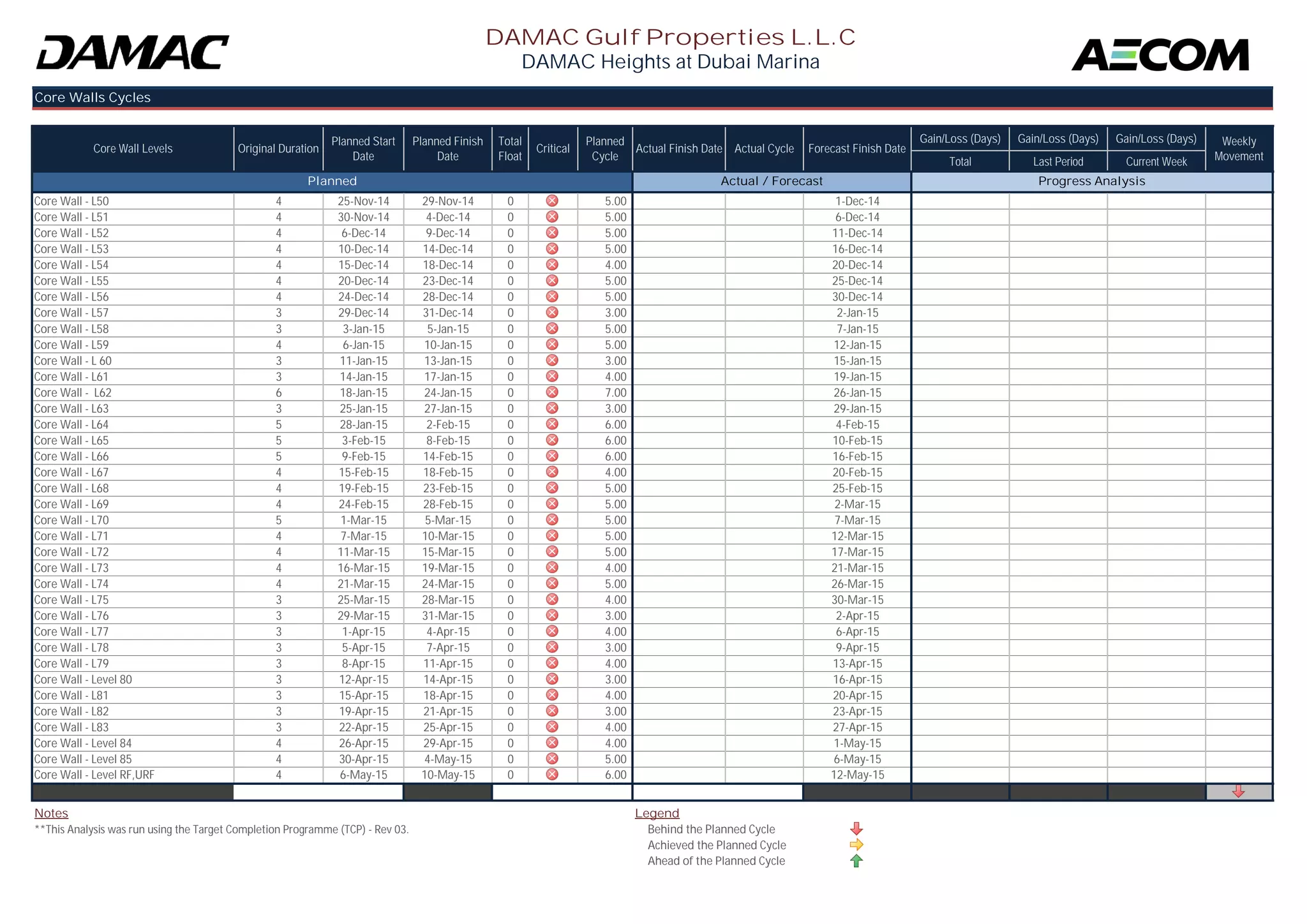

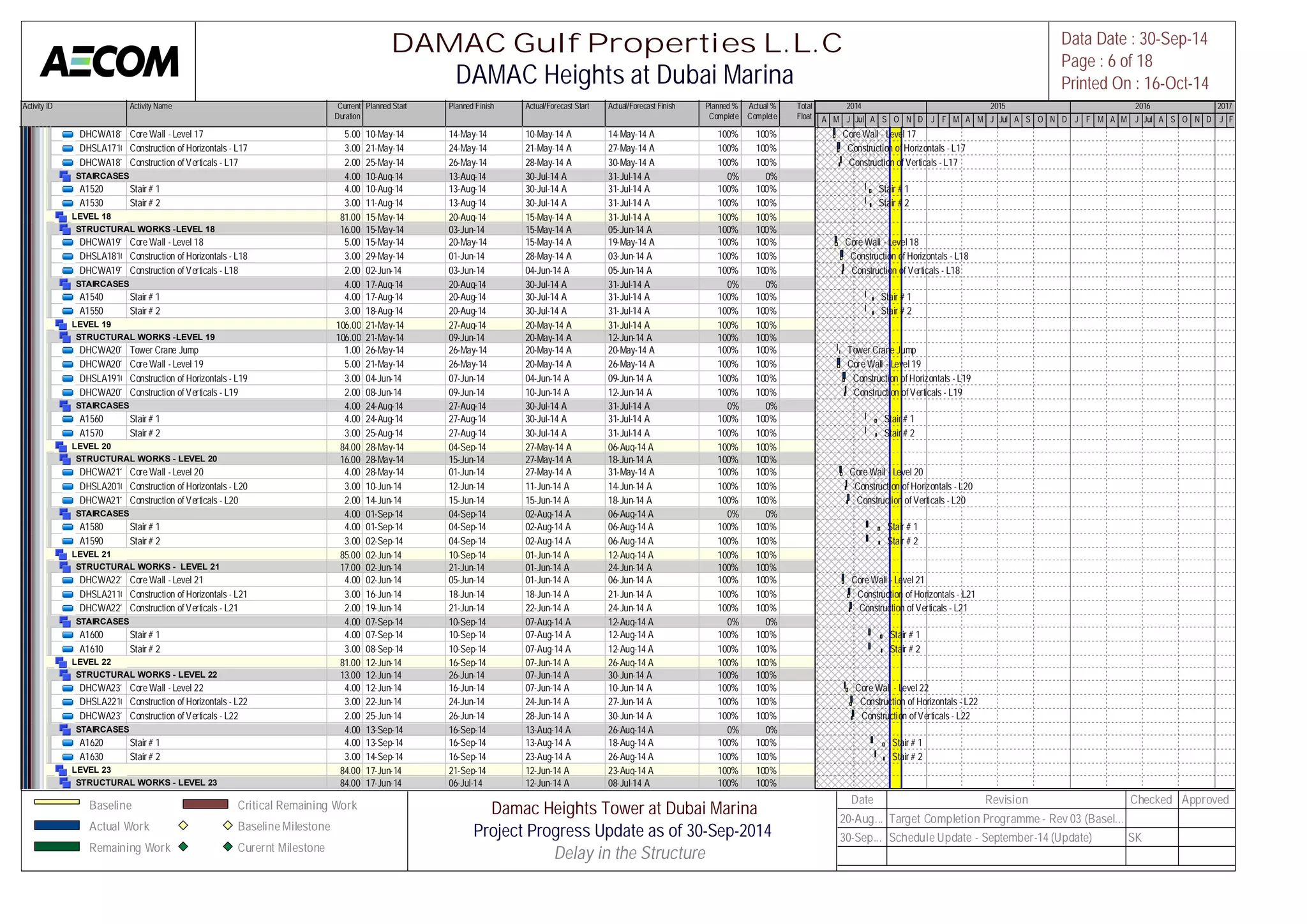

•The Slabs were poured up to level 36 and core walls were poured
up to level 38. The stairs were poured till level 28.
• The average cycles are 6 days for core walls and slabs.
• The work in zone B was suspended due to the seepage event.
However, secant piles breaking is going on in section BB
progressing 81% complete.

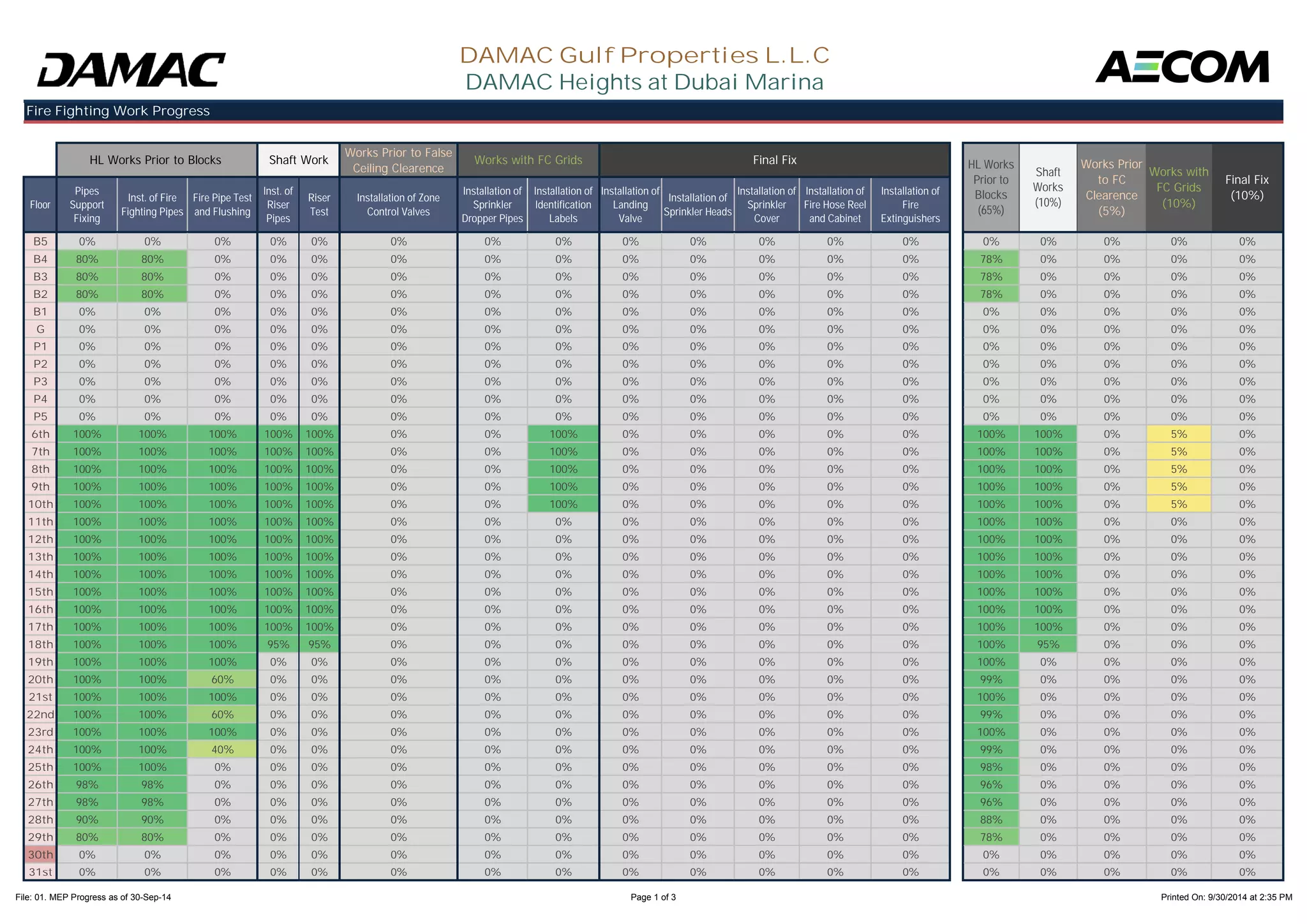

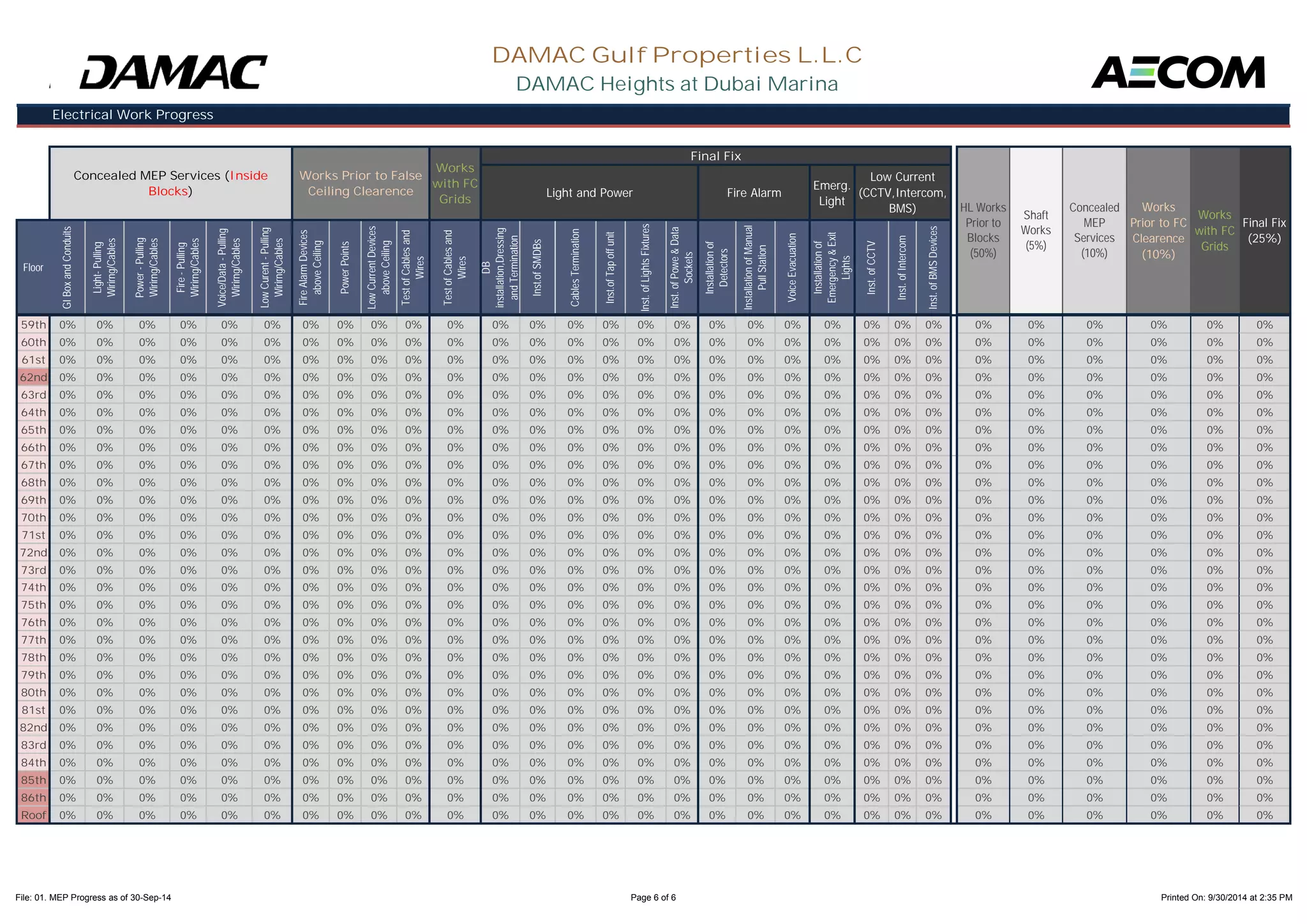

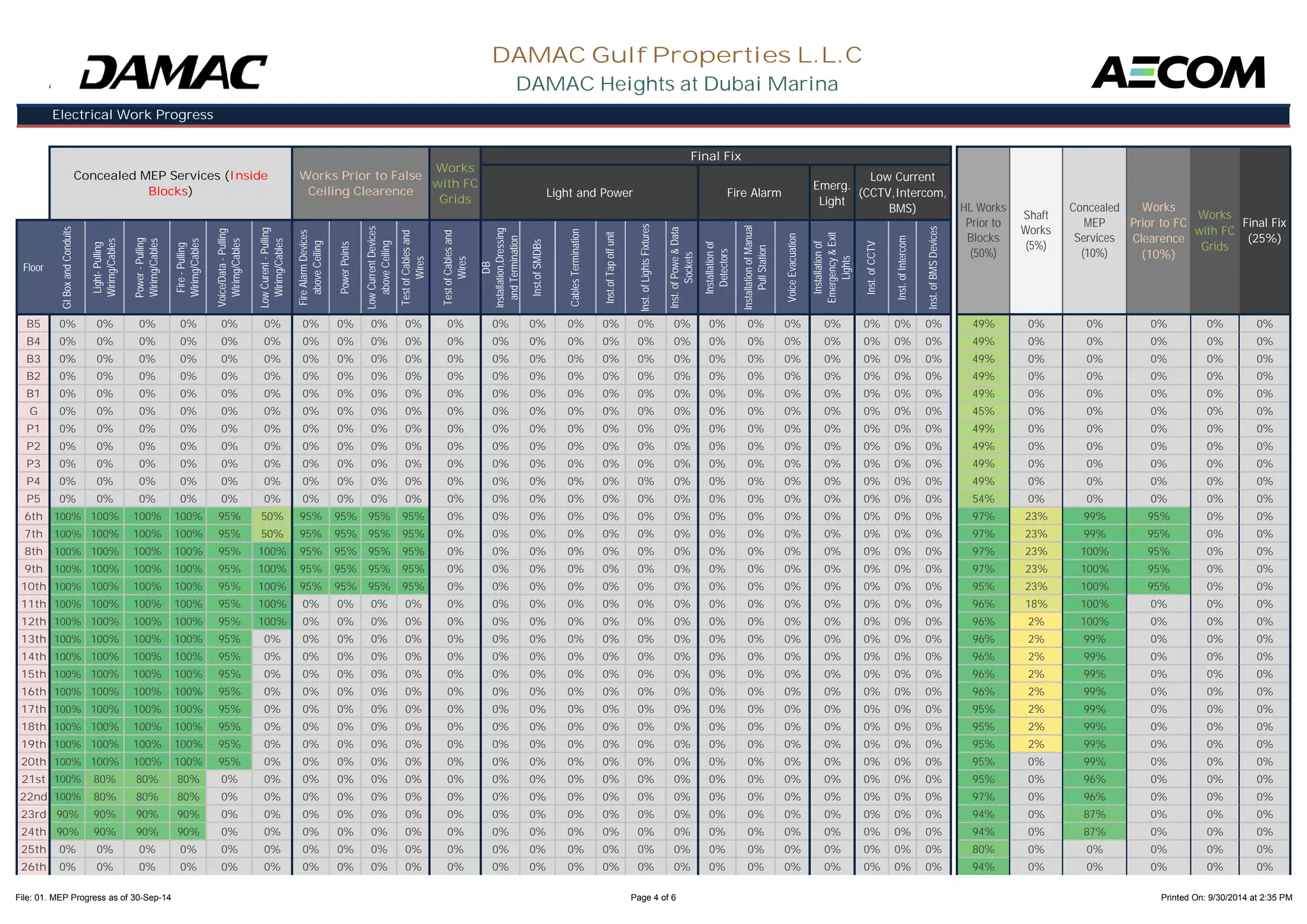

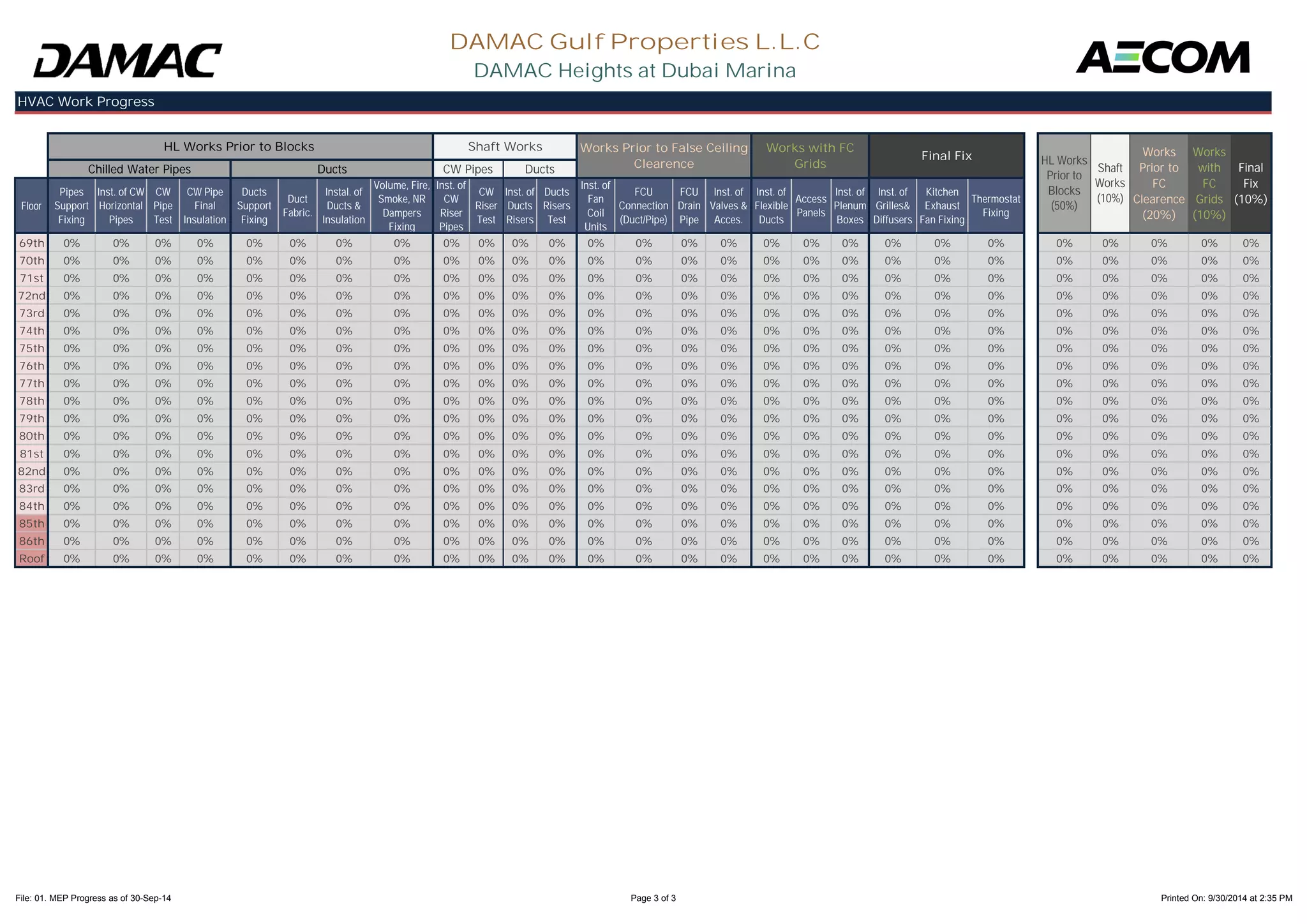

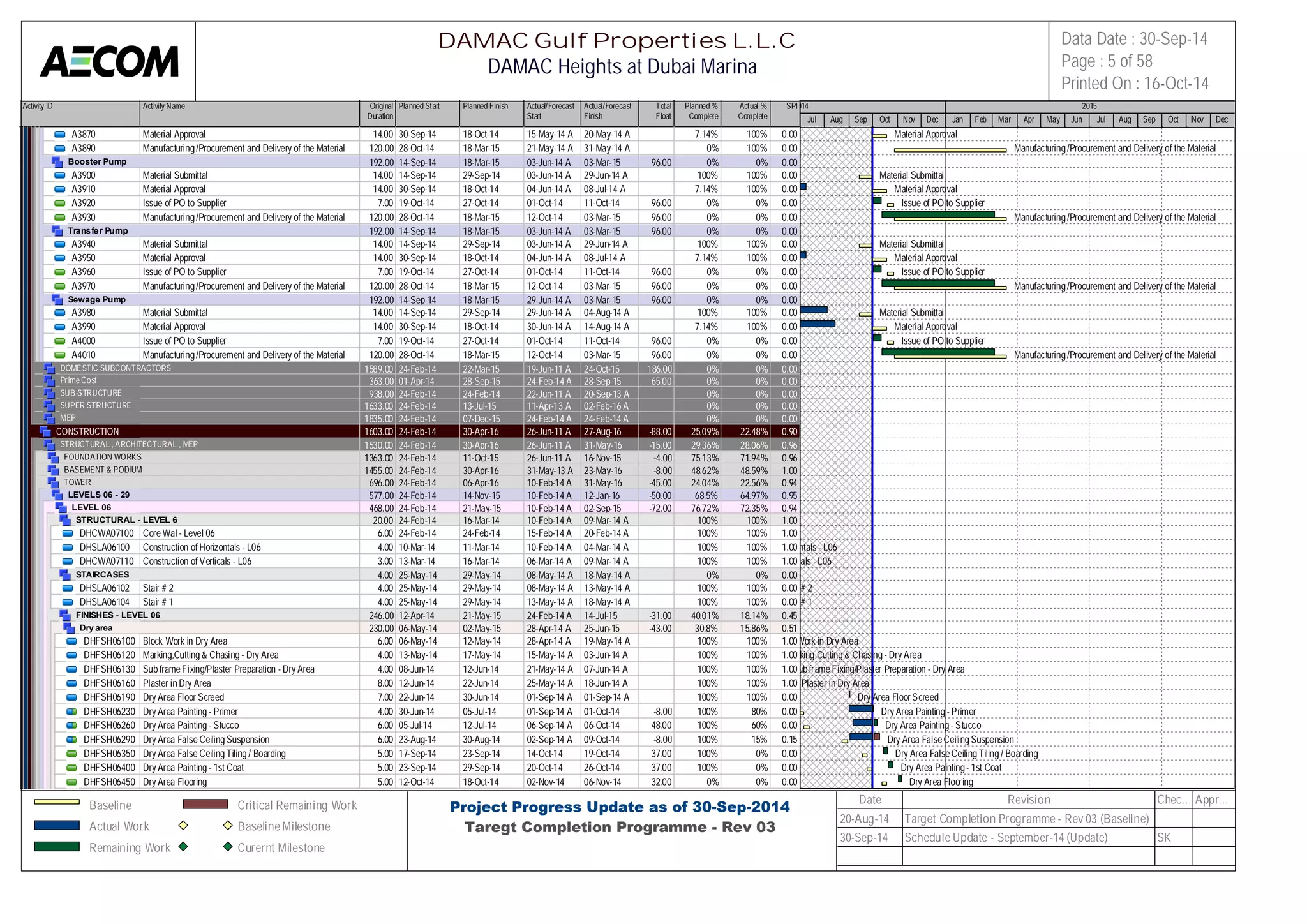

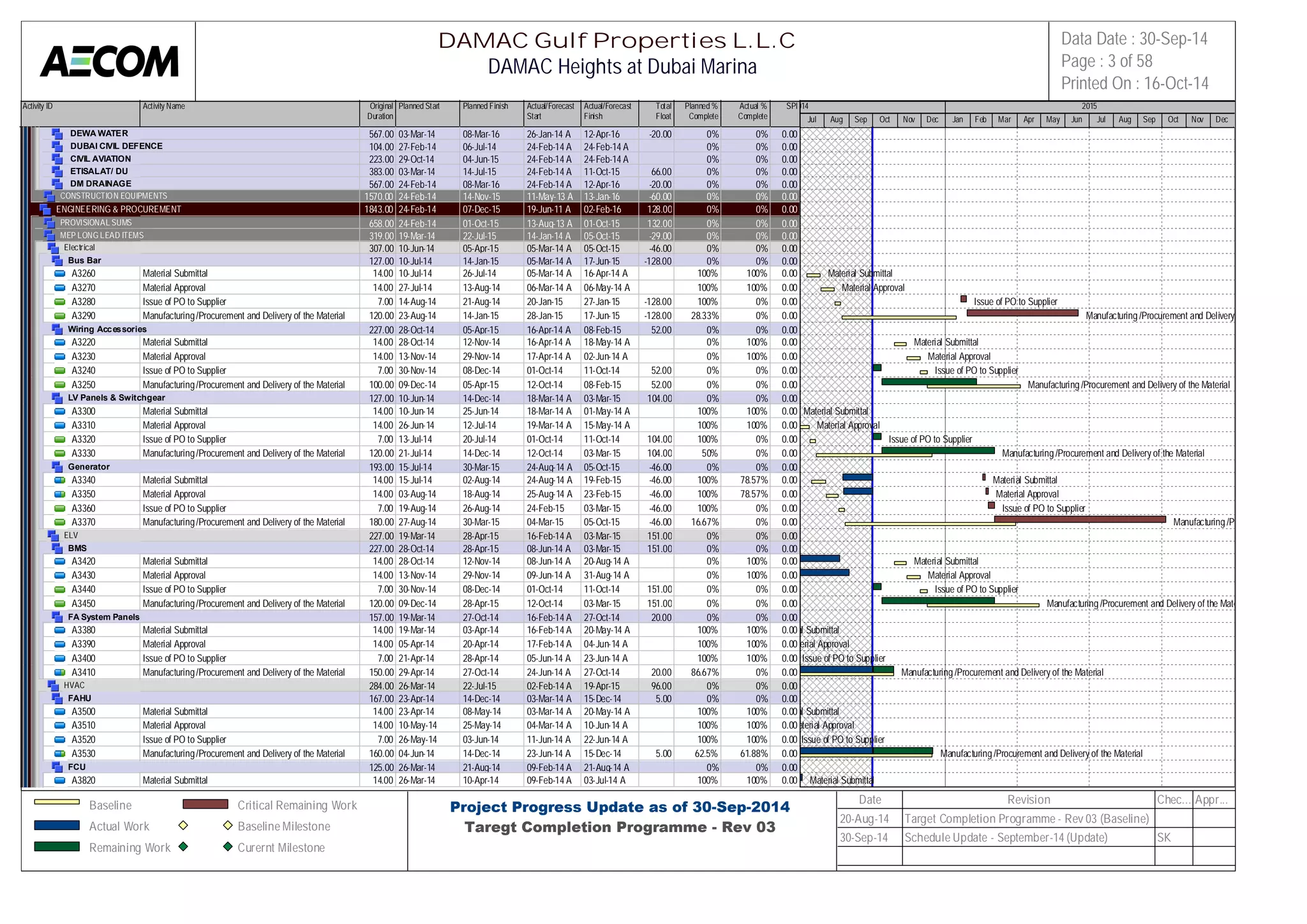

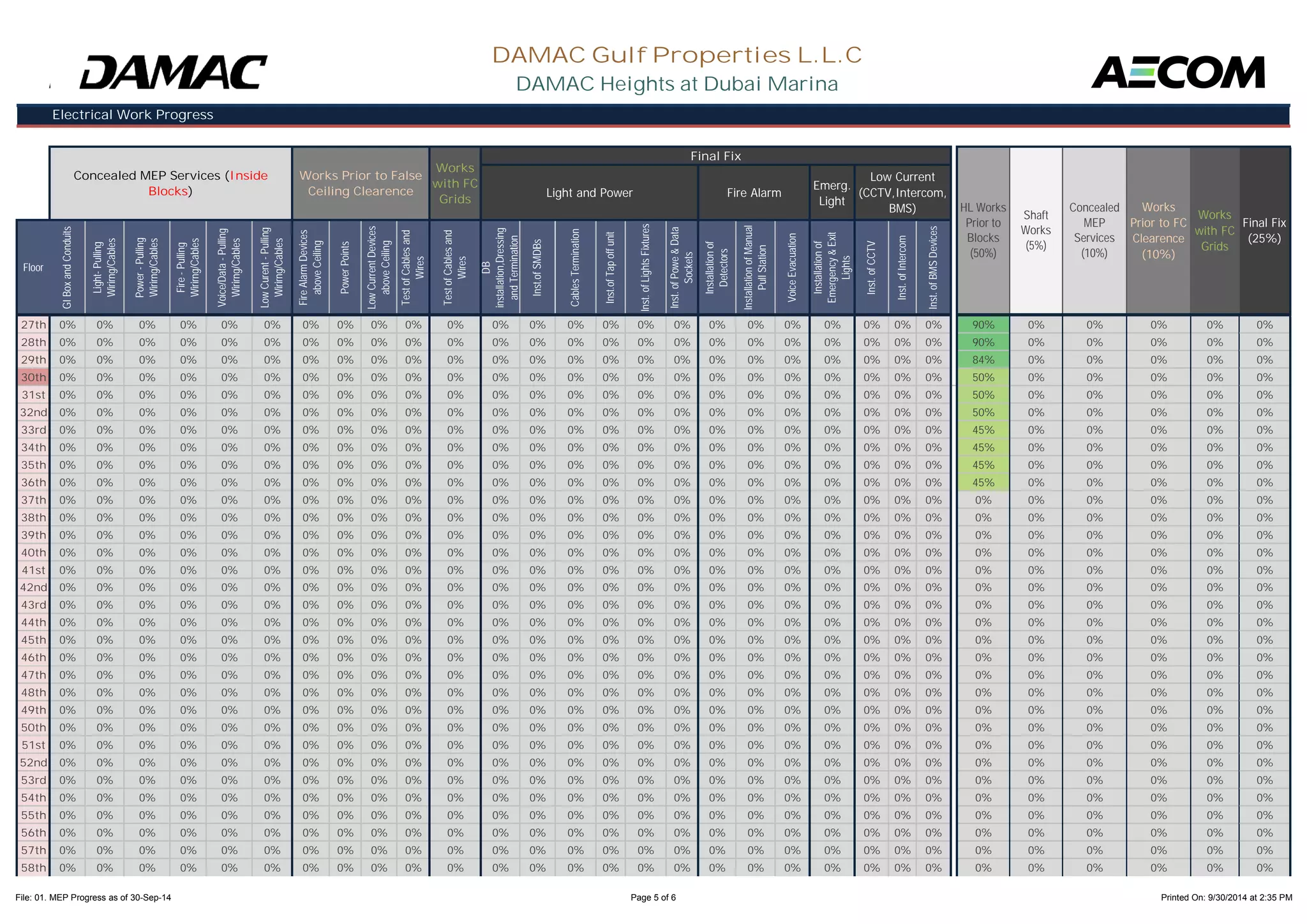

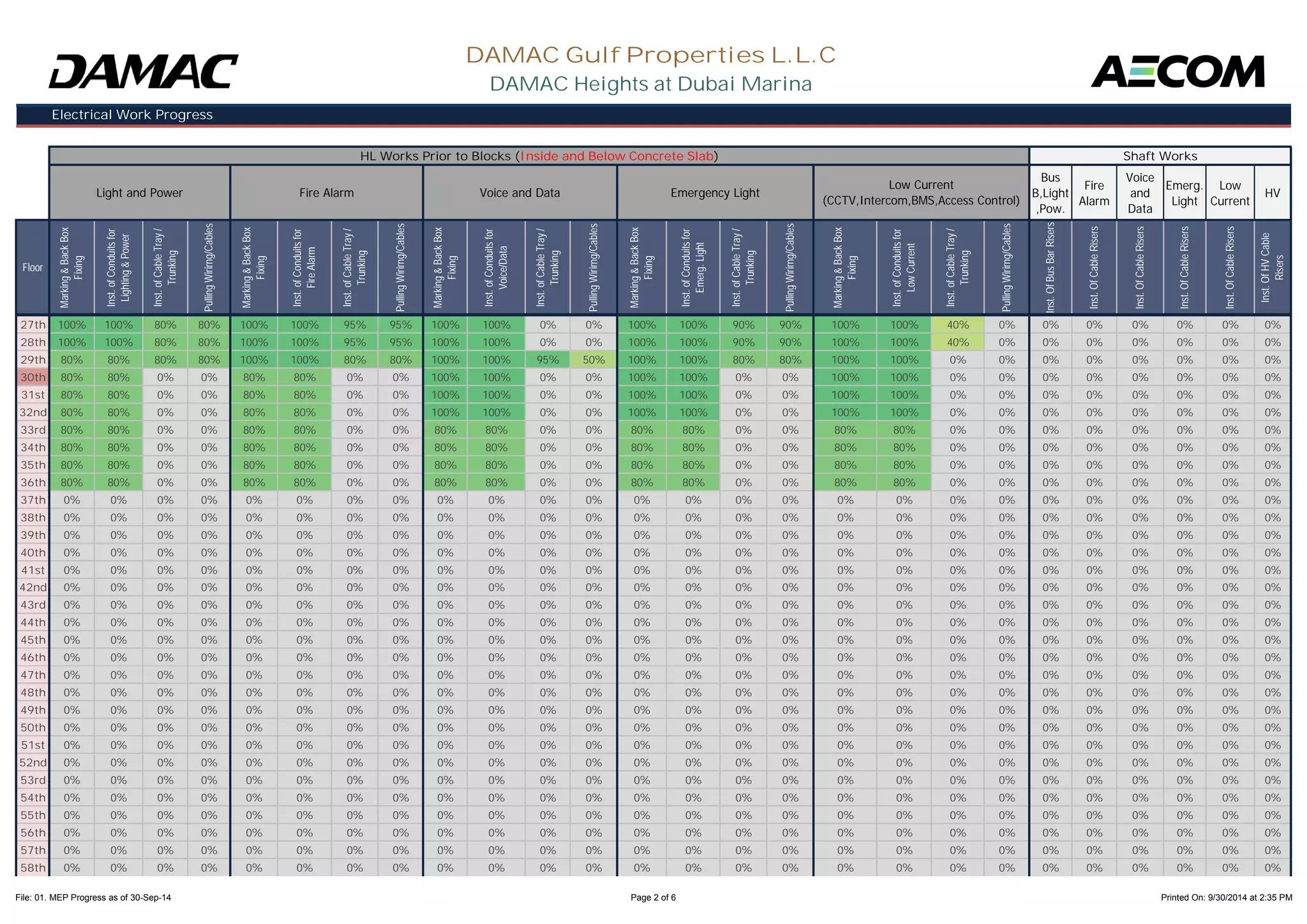

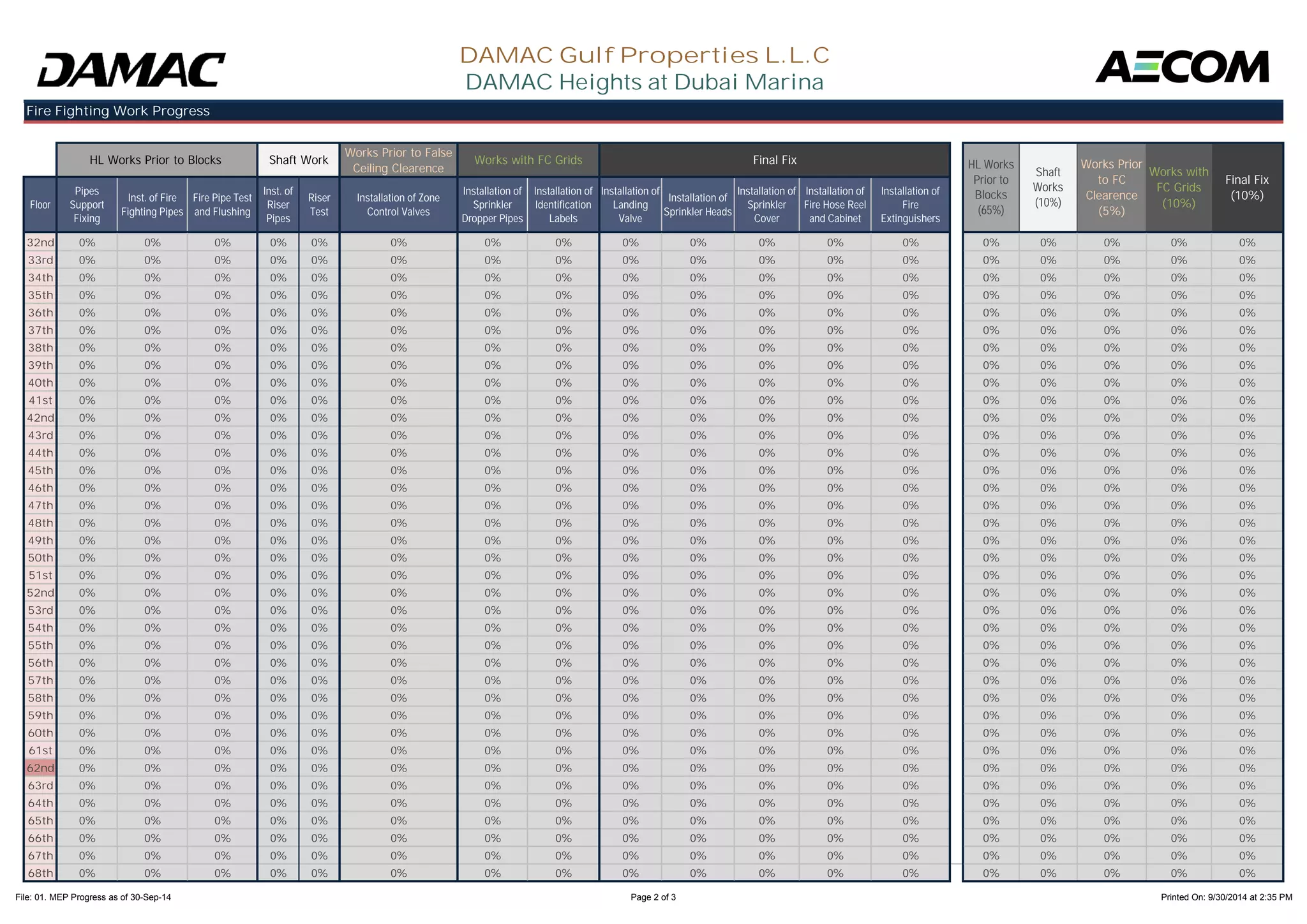

MEP
• MEP High Level works are progressing in levels B5,B4,B3,B2 and
6 till 31.
• MEP concealed works are progressing from level 6 till 24.
• MEP risers- HAVC are progressing from level 6 till 22.
• MEP risers- Fire Fighting are progressing from level 6 till 18.
• MEP risers- Plumbing are progressing from level 6 till 31.
• MEP risers- Electrical are progressing from level 6 till 19.
• MEP ceiling clearance are progressing from level 6 till 9.

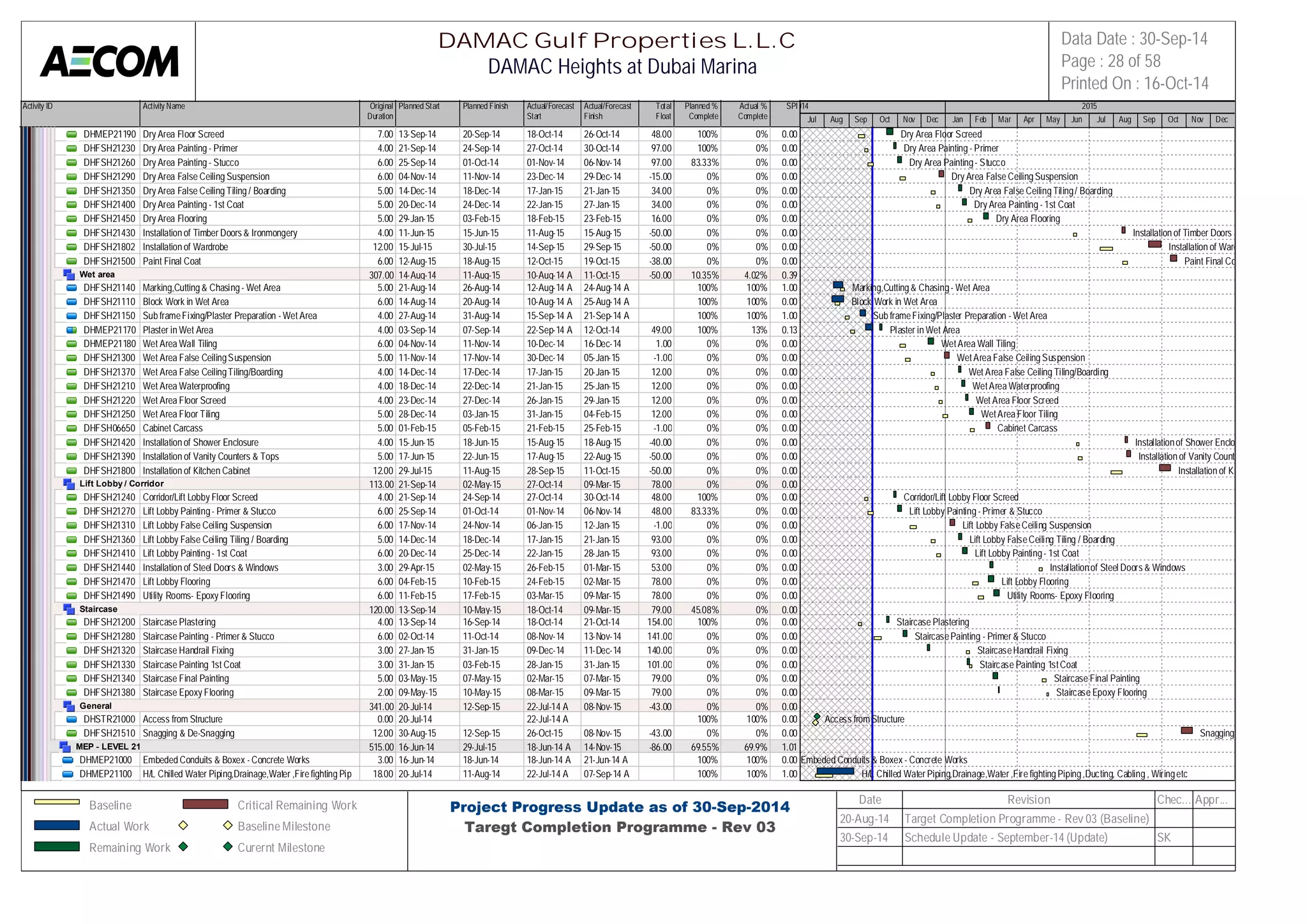

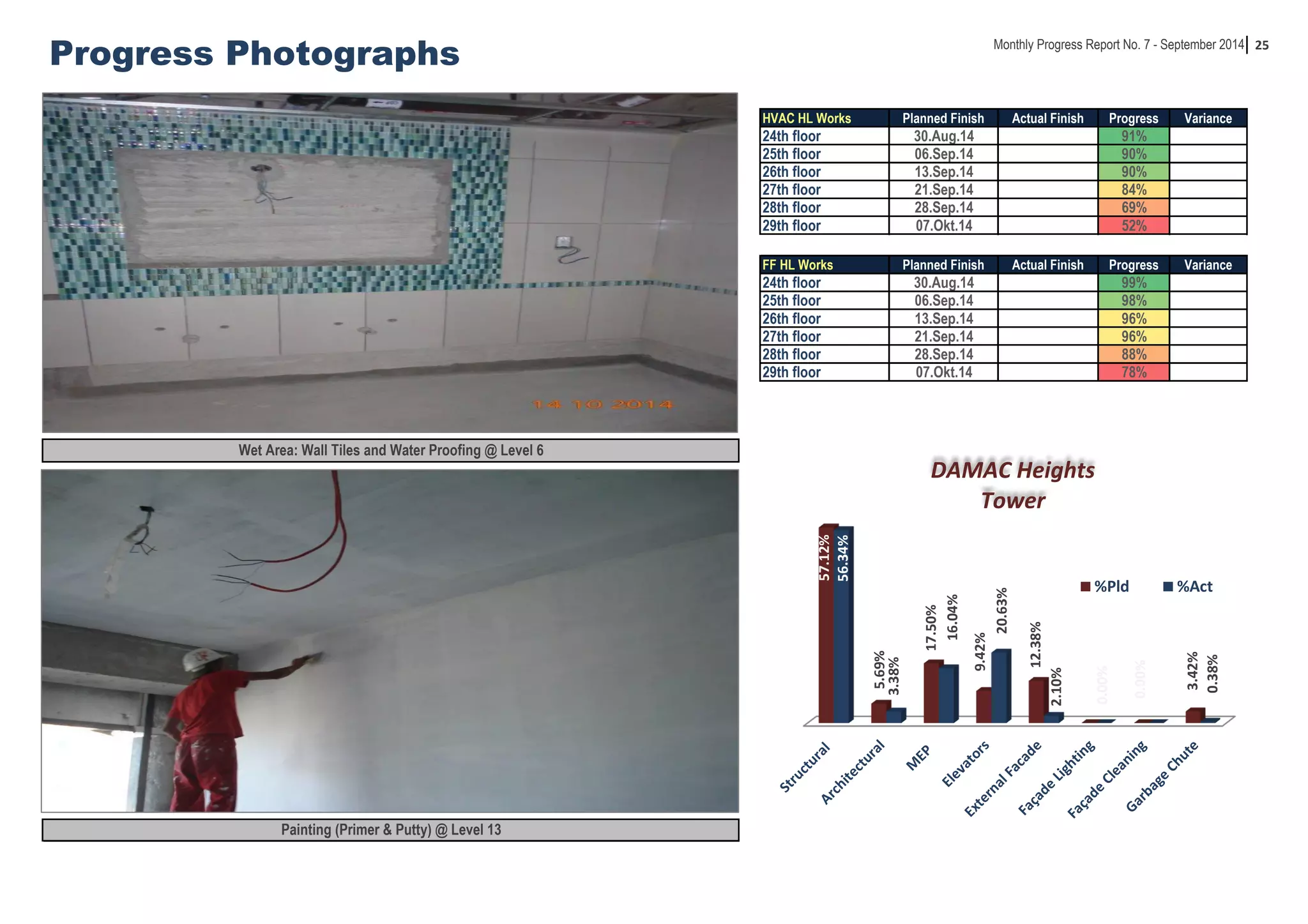

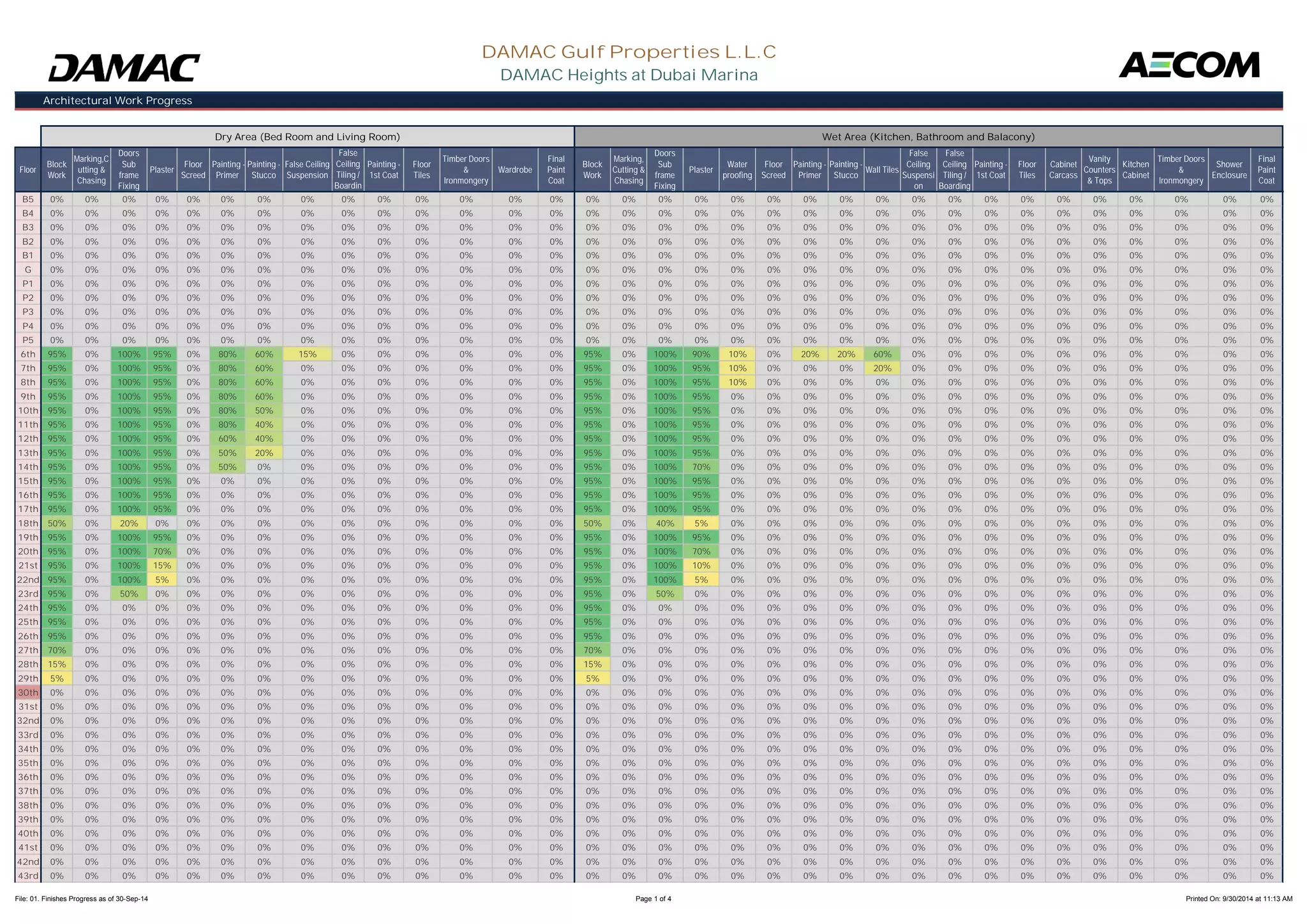

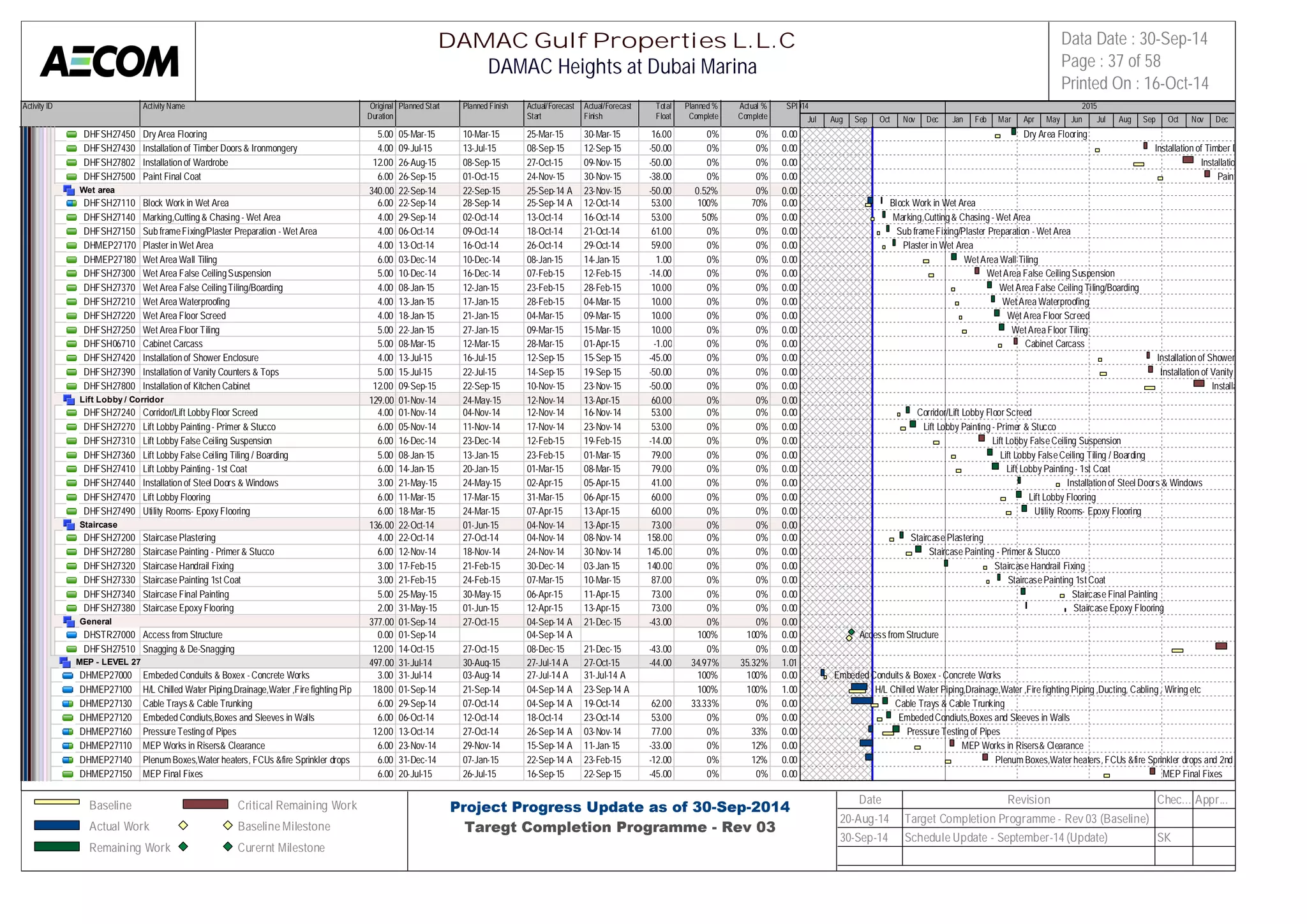

Finishes
• Block work is progressing from level 6 till 29.
• Doors sub frames and plaster works are progressing from level 6
till 22.
• Paint work is progressing from level 6 till 14 and false ceiling
started in level 6.

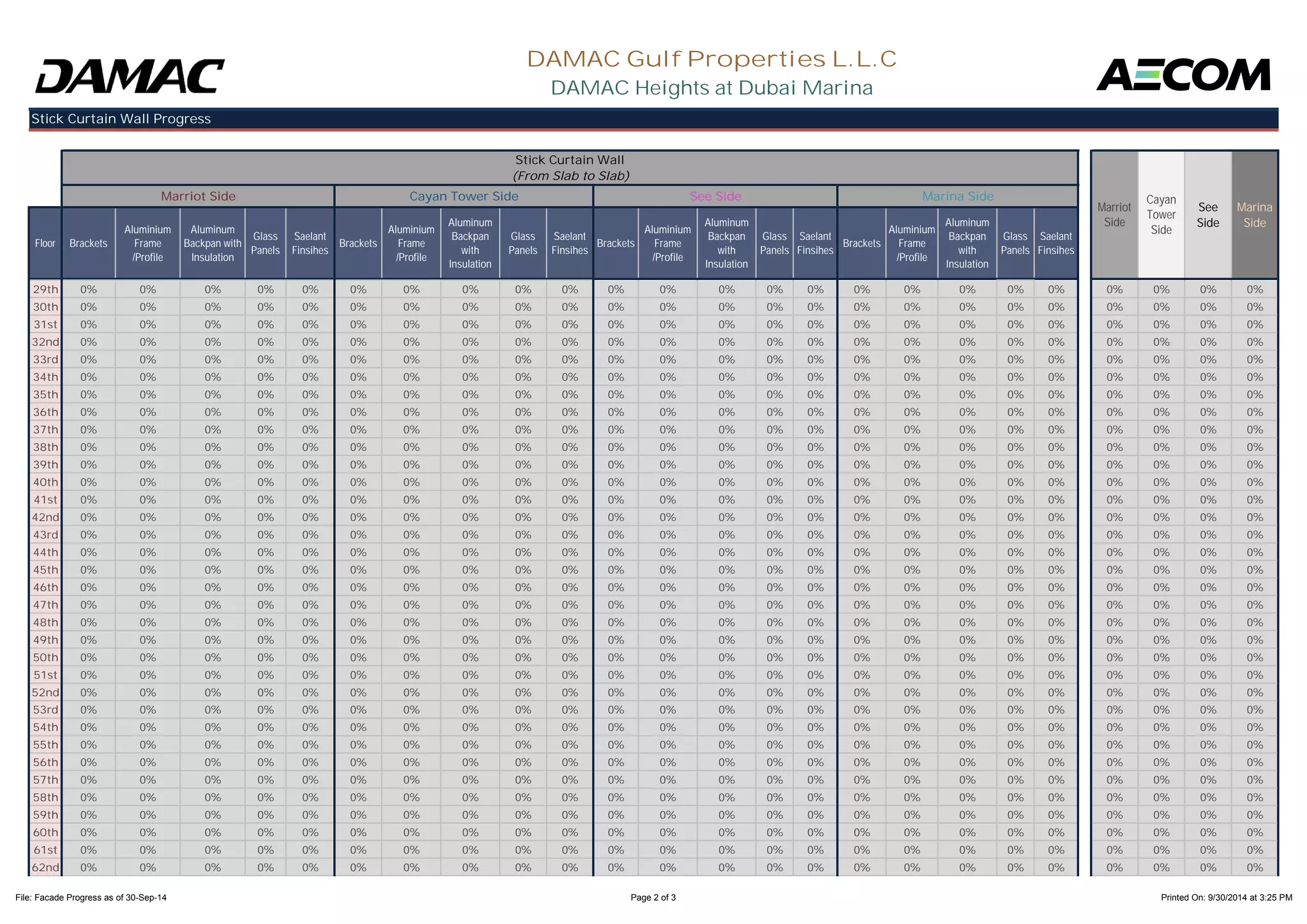

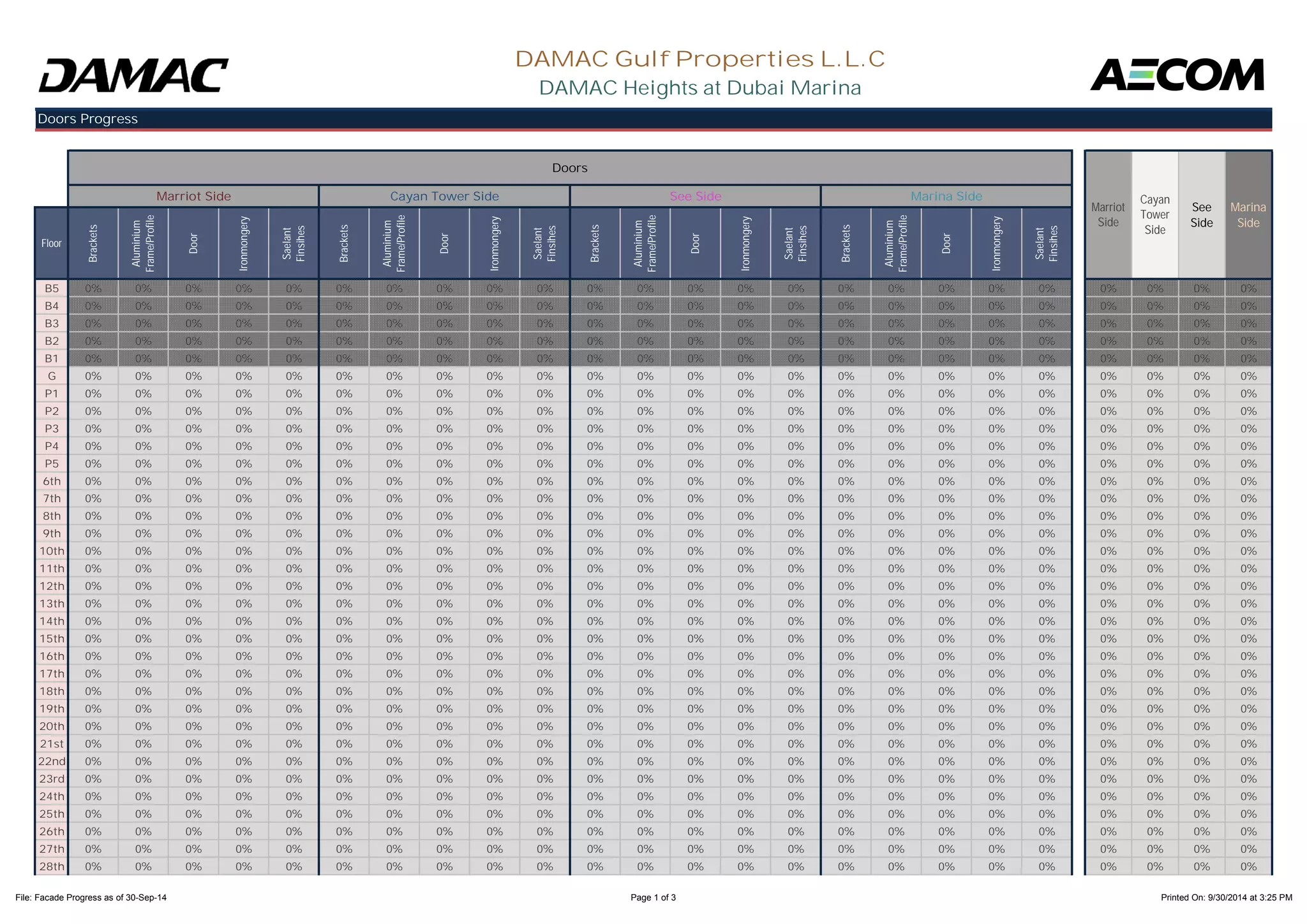

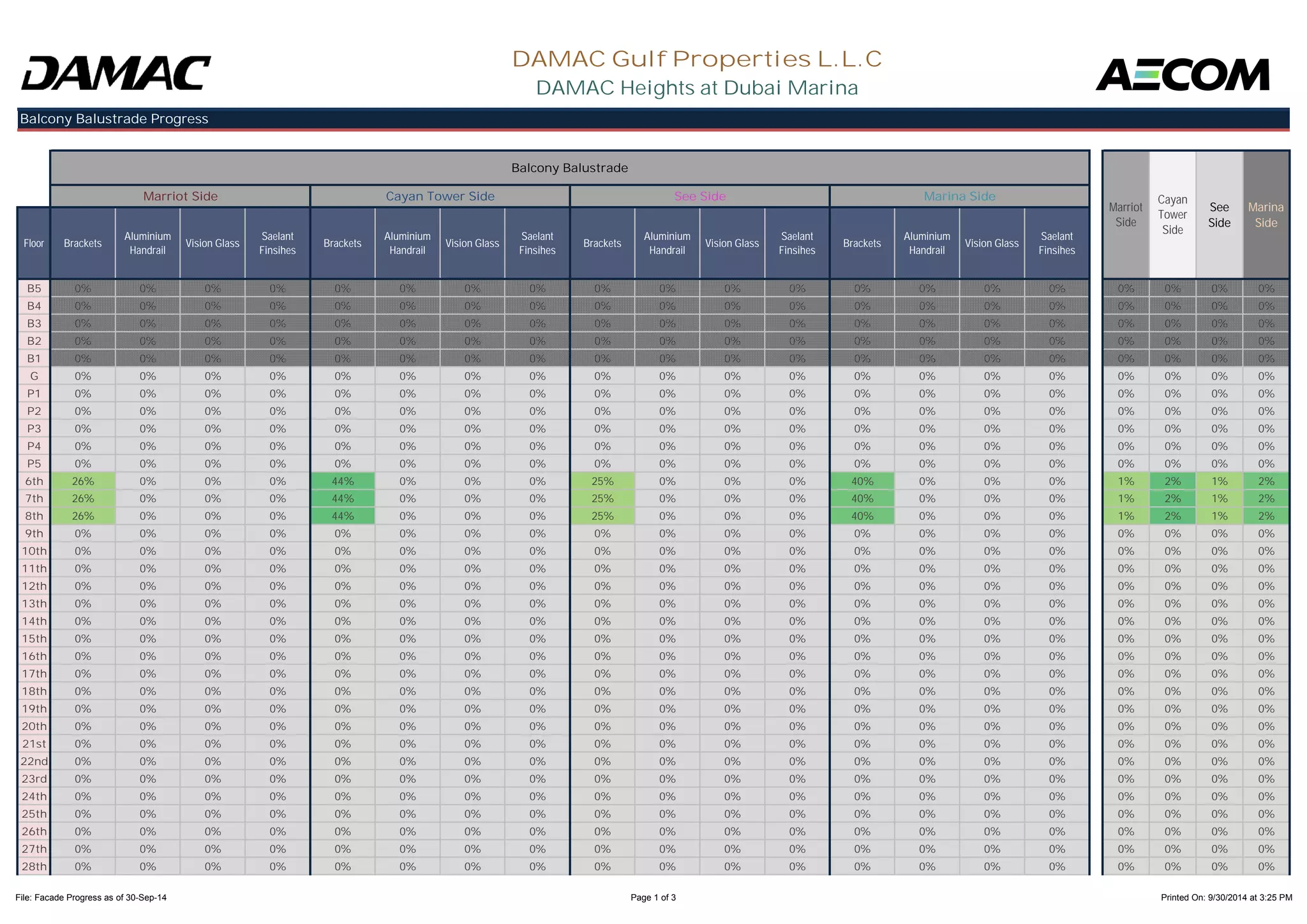

External Facade

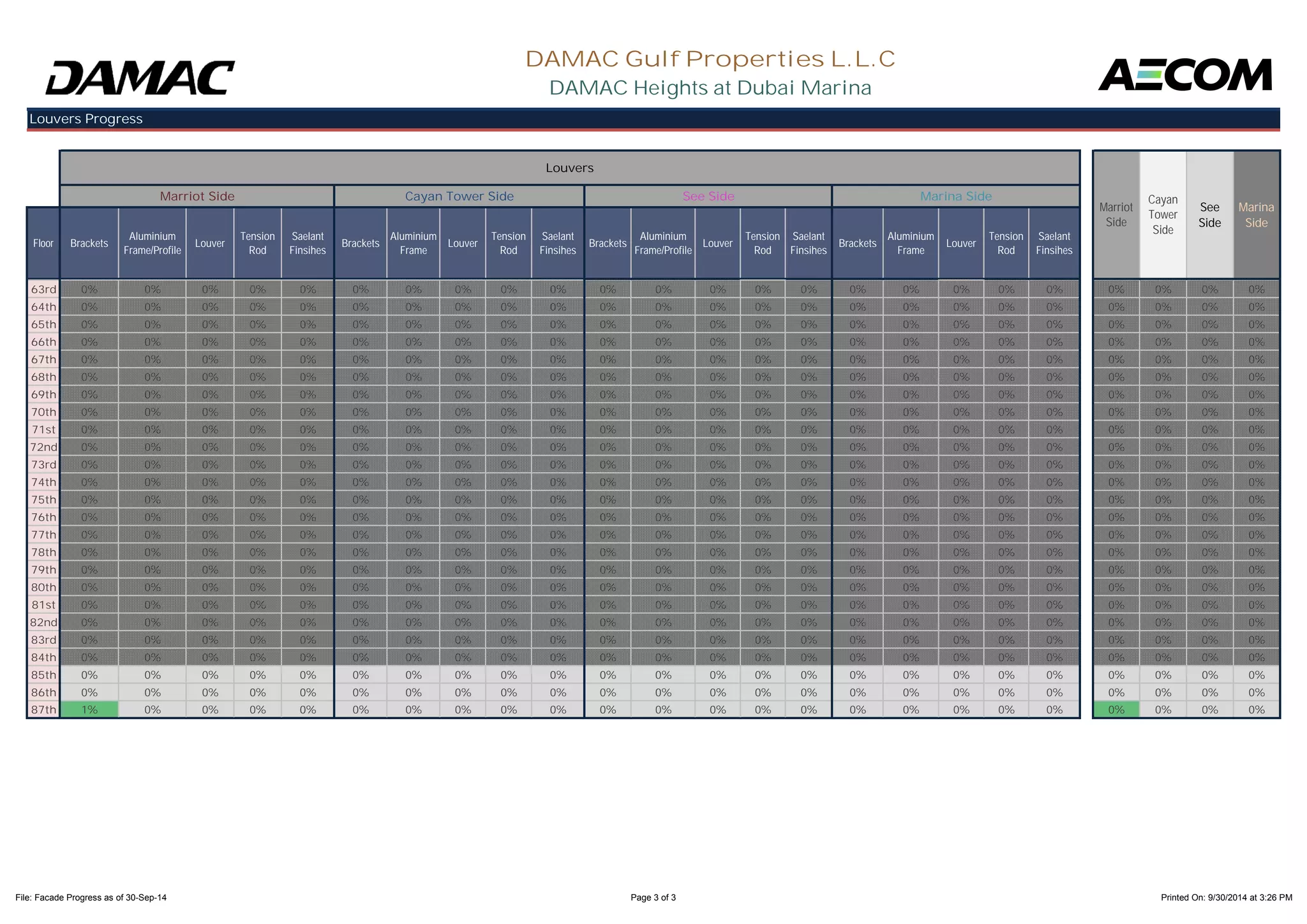

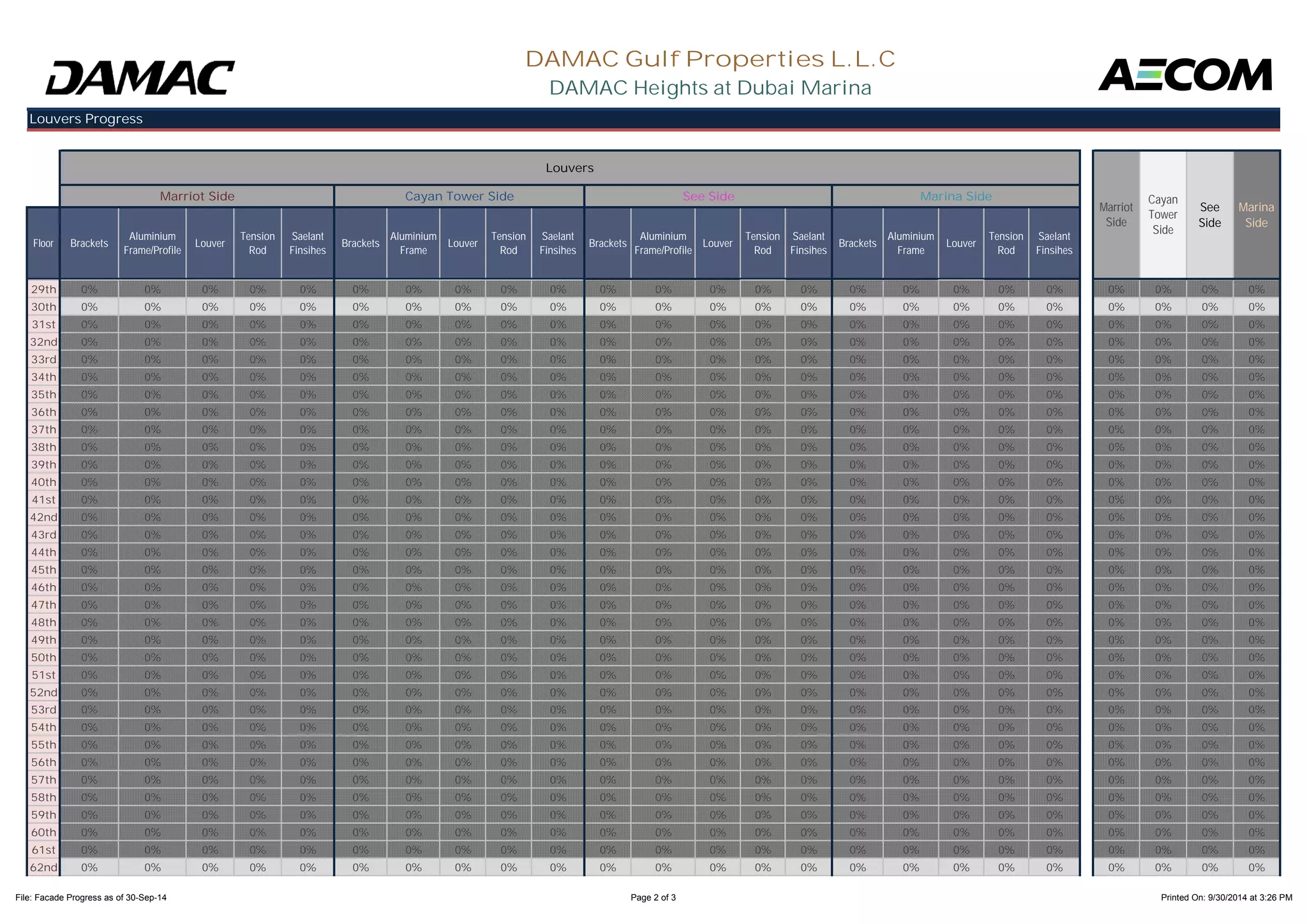

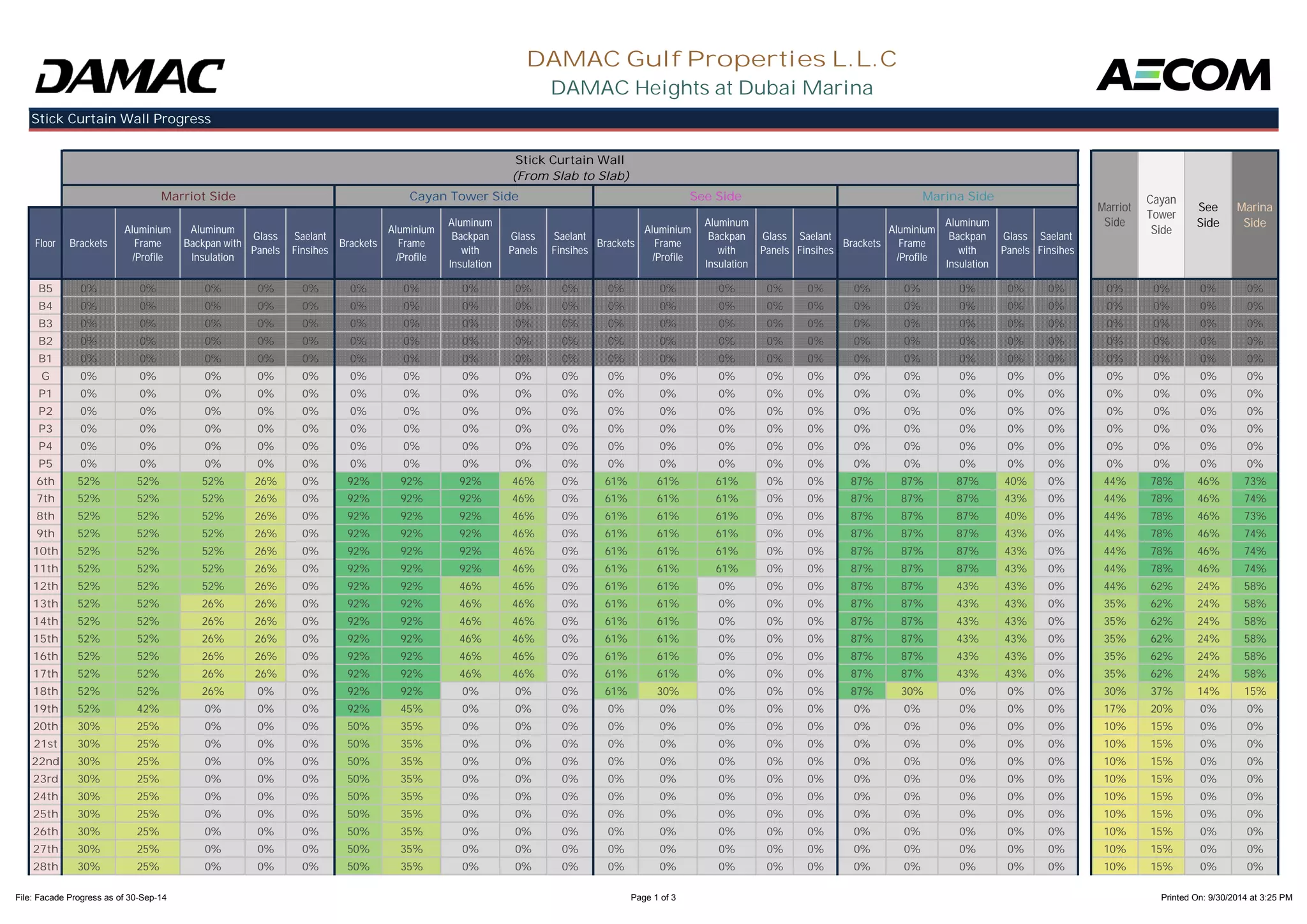

• ALICO started the installation of Stick frame curtain wall for
balconies from level 6 till 28. Also the brackets for Unitized system
and balcony balustrade started from level 6 to 8.

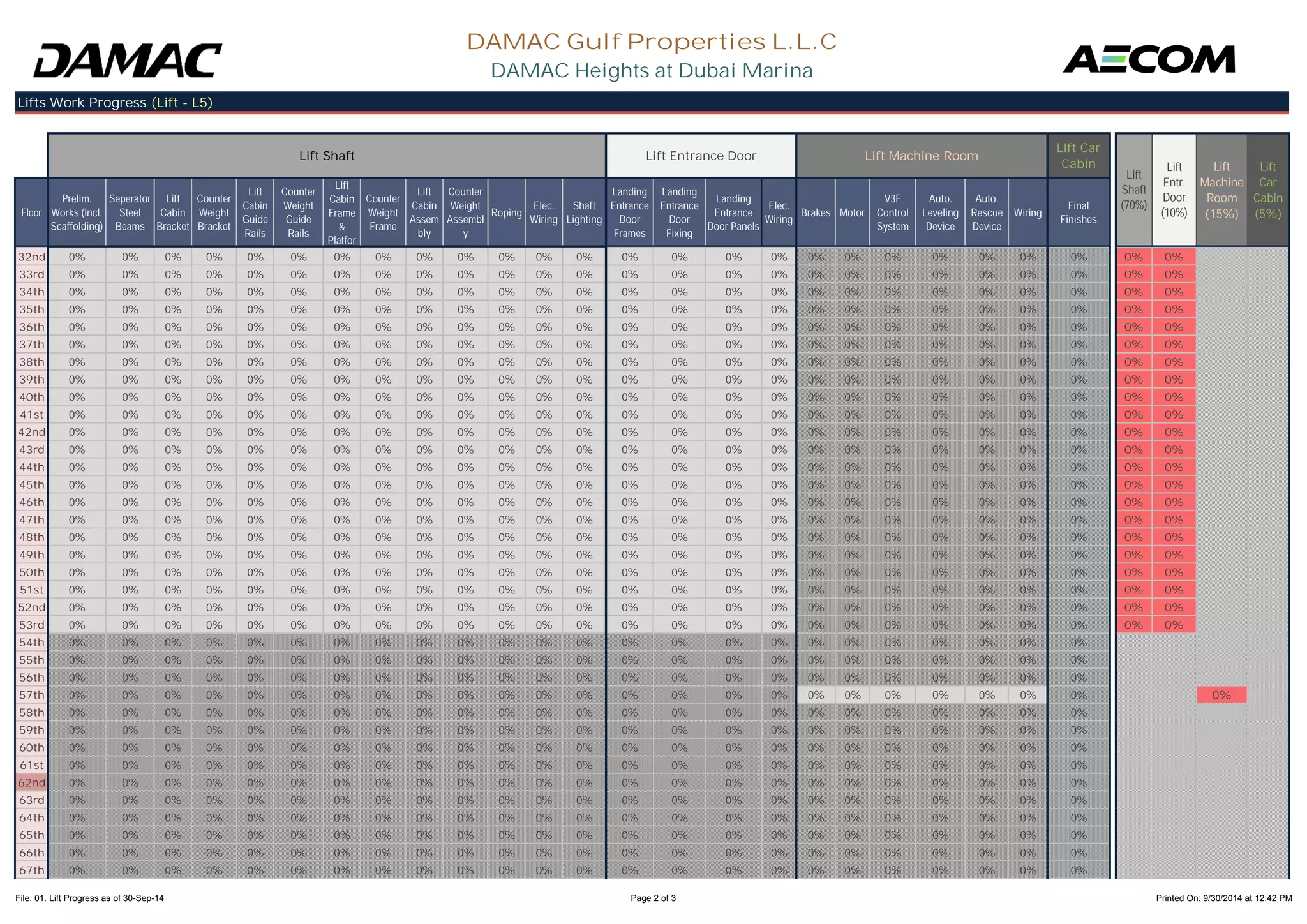

Lifts

• Toshiba started the preliminary works and separator steel beams
in the low, med and high zones.

Garbage Chute
• Garbage Chute mock up was done at level 6.

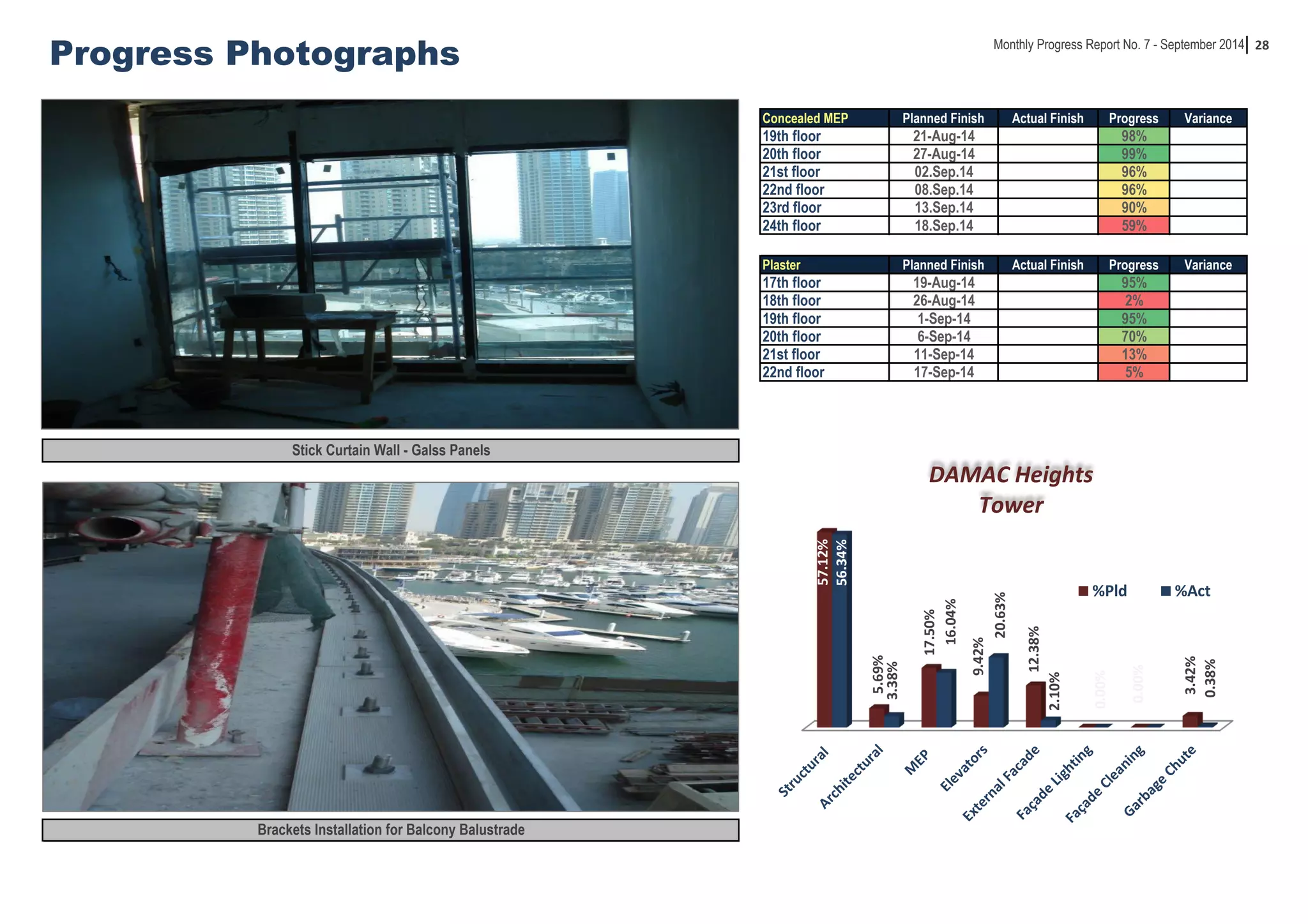

7
Monthly Progress Report No. 7 - September 2014
Key Accomplishments Key Focus Issues
Schedule Progress

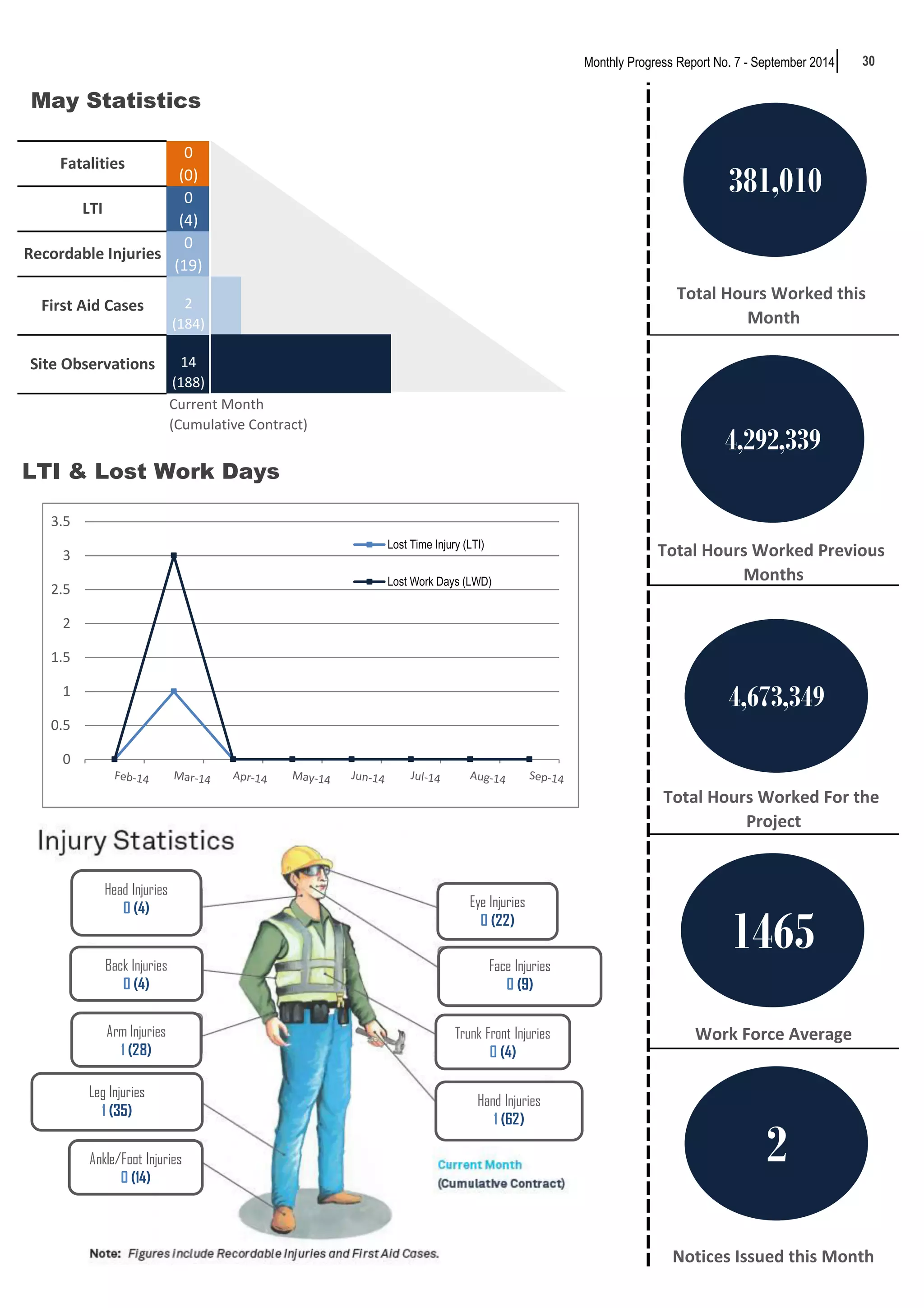

Health, Safety and Environment

Engineering

• PT shop drawings for levels (64-84) are under ATC review in order
to resubmit it again to the 3rd Party for approval.
• The LV shop drawings are ready for submission to DEWA,
however, DEWA asked for design NOC's renewal before going
further with drawings submission for review.
• ATC continues preparing the shop drawings for false ceiling.
• AECOM is preparing a proposal to have a permanent solution to
the diaphragm wall.
• ATC is preparing the fabrication drawings for the secondary steel
structure of level 5.
• A proposal for balcony rain water risers was submitted to Damac.
• Approval has been obtained for FF and FA of level 5 from Civil
defense and DM.
• AECOM is working to provide Zone B's de-strutting sequencing.

• Material submittal for intercom system, MV switch gear, generator
and laminated Glass for Balcony Partition were approved.
• DAMAC advised that the decision is to proceed with stone
cladding and a sample sent to ATC.
• An instruction was given to ATC to proceed with procuring the Bus
bars and LV Panels.
• The purchase order issued for Corridors tile.

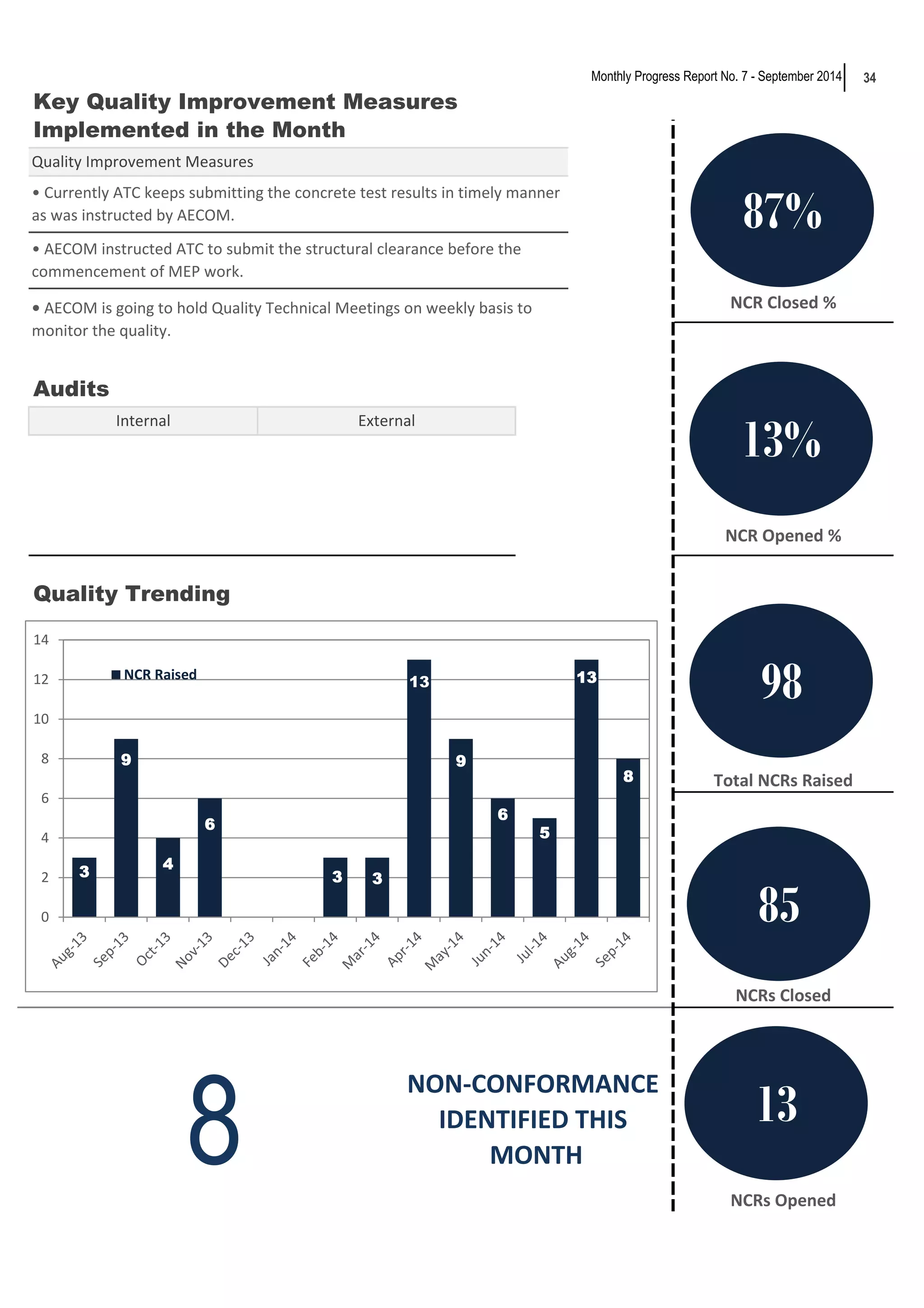

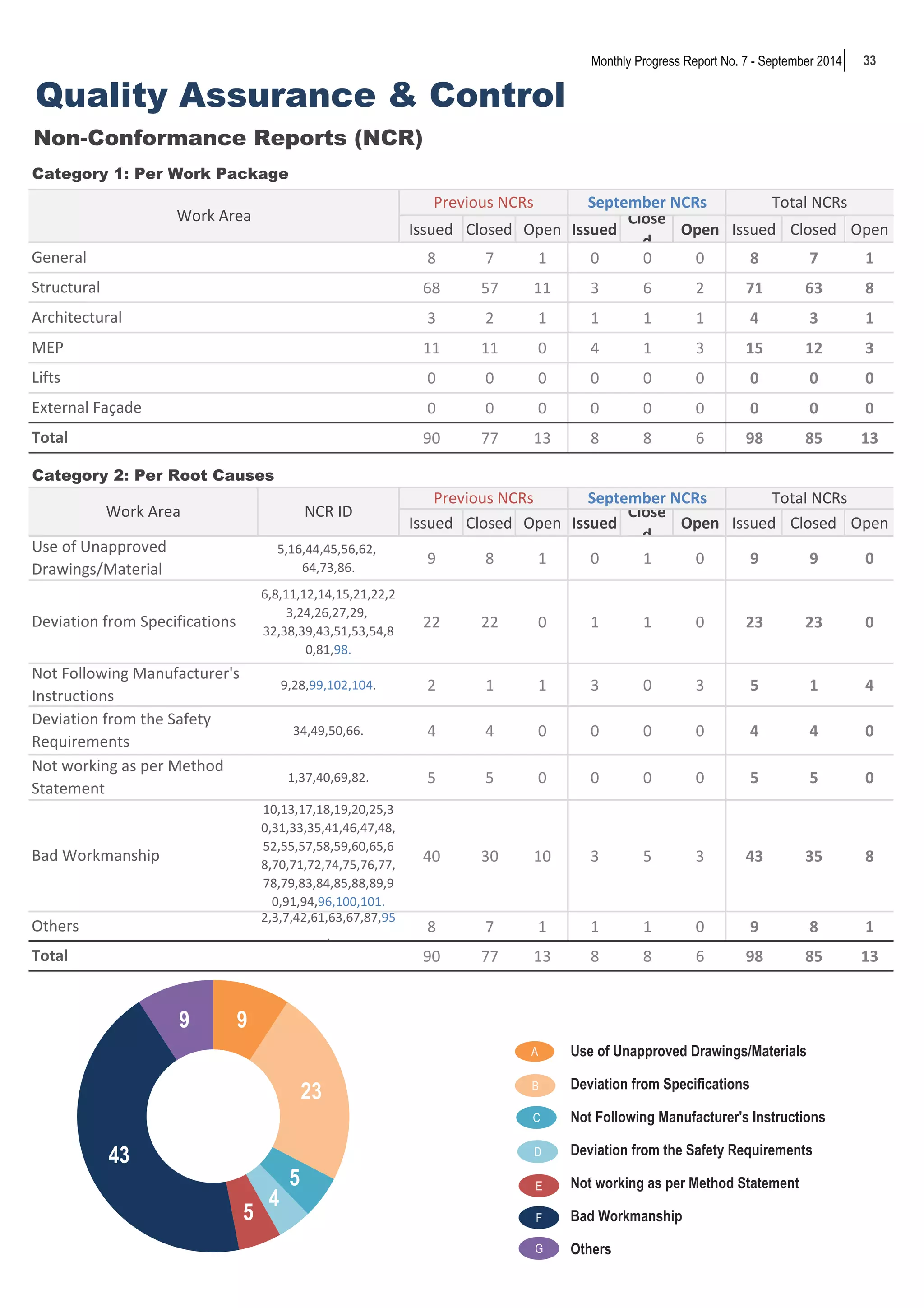

Quality Assurance and Control
• 98 NCRs were issued to date and 85 of them are closed.
• 8 NCRs were issued during this month.

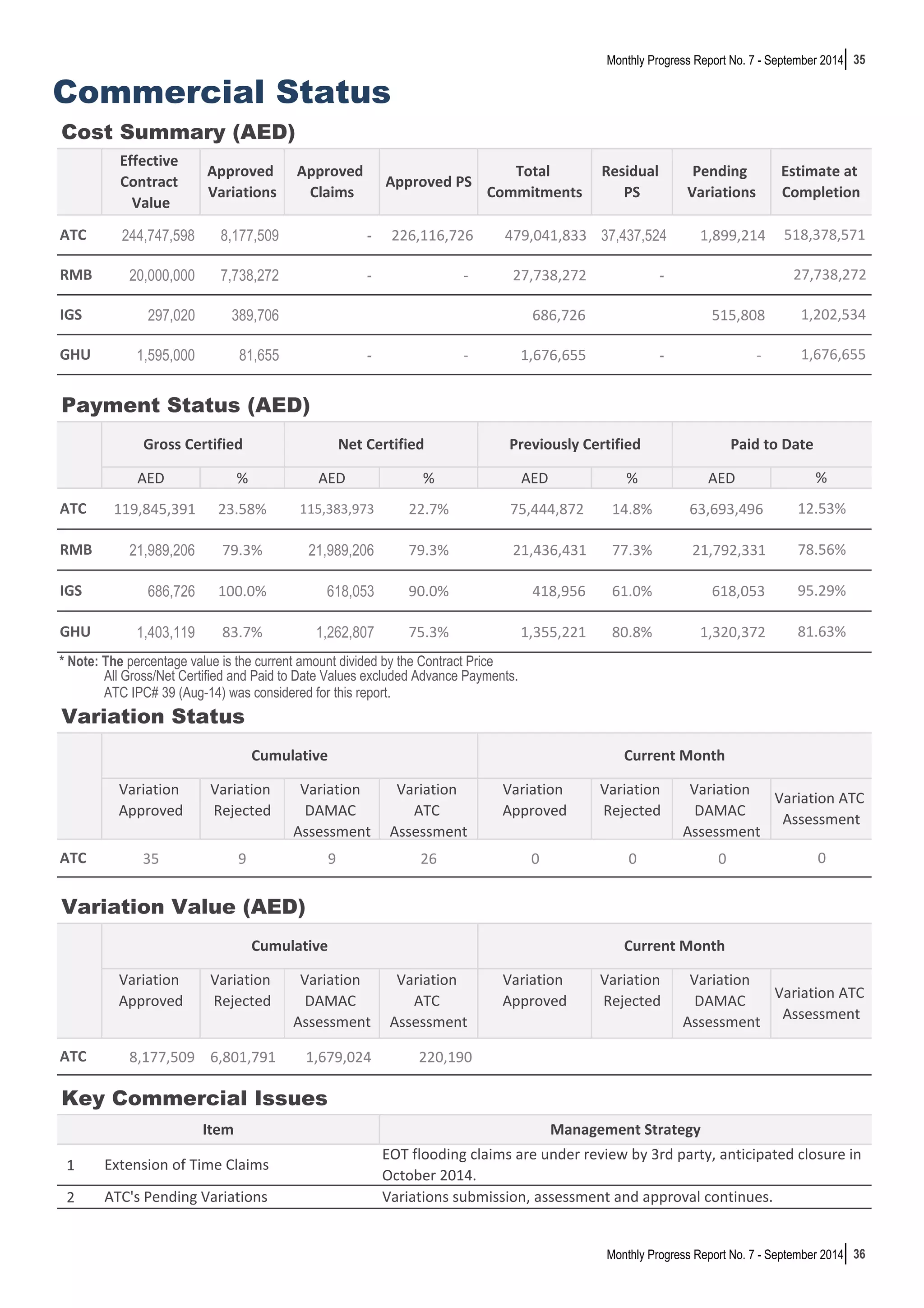

Commercial Status
• The flooding delay events are still under review by 3rd party. No
action is possible on ATC's claims until such time as the EOT
decision is reached.
• Variations submission, assessment and approval continues.
• AECOM asked ATC to submit the PI insurances.
• Payment Certificate (IPC) for August 2014 is under review.
Procurement
• RME has to release the Steam and Sauna package.
• DAMAC has to finalize the nomination of façade light.
• DAMAC to re-nominate the sanitary wares package.
• ALICO to provide the factory production progress report showing the status of
fabrication and the expected delivery dates.
• ALICO to expedite the delivery of Cladding Panels and Unitized Curtain Wall
System.
• REMCO has to issue the purchase order of the Bus bars and LV Panels.
Quality Assurance and Control
• ATC has to improve the quality of concrete works.
• ATC has to give the structural clearance before the commencement of
MEP works.
• ATC to improve quality of submittals to avoid ,multiple re-submission.
Procurement
Commercial Status
• Final concluded report of flooding events has to be issued by DAMAC in order
to enable Arabtec to issue a revised clause 14 that will reflect the new
completion date.
• Processing of agreed variations.
• Processing of contractor IPCs in line with the contractual time frame.
• ATC issued the Target Completion Programme - Rev 3 and it is
under the Engineer's review. The comments will be issued to
Arabtec by 2nd week of October 2014.
Health, Safety and Environment
• More work has to be done regarding the overhead protection.
• House keeping needs improvement by ATC.
• Excavation at sections B-B and D-D is a high risk activity.
• Water Seepage at section DD and BB has to be monitored closely.
• ineffective pest control in the project site offices.
• Emergency escape route from level 27 to level 30 is inadequate.
• More work has to be done to control the dust of Garbage Chute.
•10 site observation were closed during the month of September
2014 and 2 notices were issued.
• Number of first aid cases in September 2014 was (2) and (3)
cases were recorded for near misses and (0) cases for LTI.
• 308 orientation for new hires and 195 tool box talk were done
during September 2014.

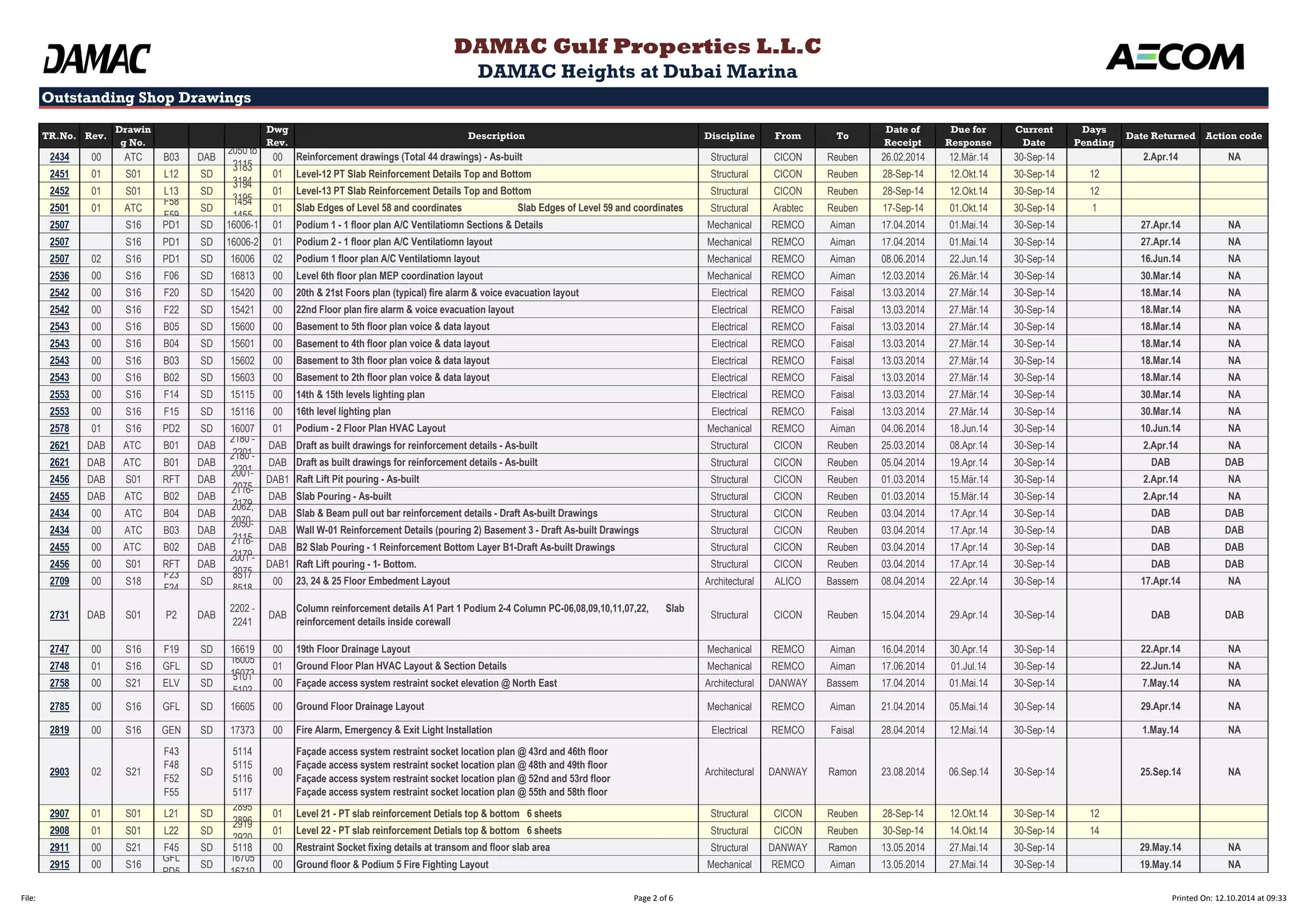

Engineering

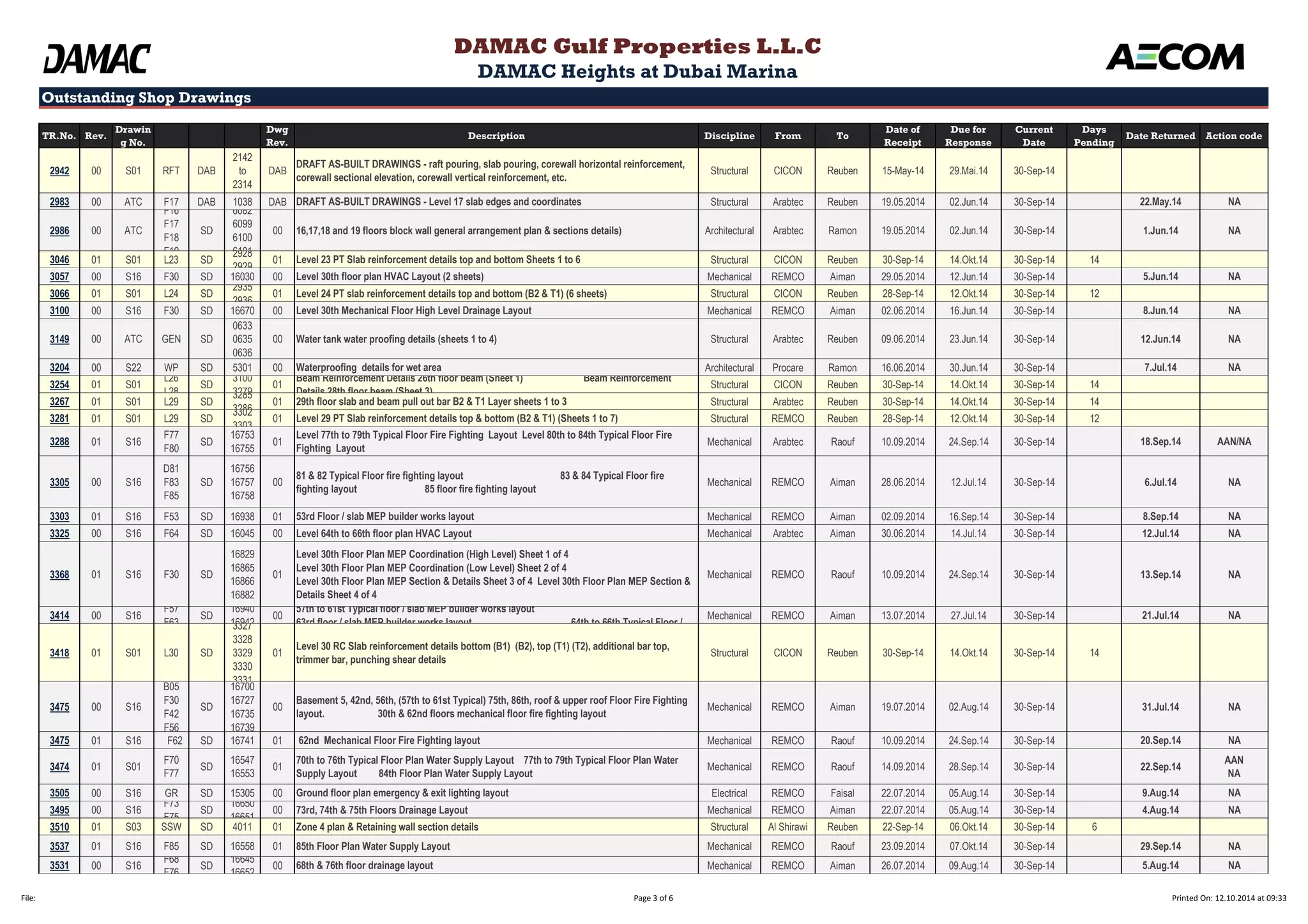

• PT drawings for levels (64-84) has to be resubmitted by ATC for review.
• Ramboll to provide updated drawings considering the missing electrical points
for level 43 and above.
• ATC to issue fabrication drawings for secondary steel structure for P5.
• AECOM to prepare a proposal to have a permanent solution to the diaphragm
wall.
• AECOM to propose the sequencing of de-strutting for Zone B.
• Ramboll to update the RCP plans considering the existing MEP provisions and
the bulkhead dimensions for levels 6 till 38.
• Arch and MEP design drawings (IFC) for Fendi floors from Level 43 to Roof
has to be finalized.
• ATC/ALICO to advice about the slab edge clashes with the façade various
upper levels.
• Pool designer's full design package to be issued in order to allow DAMAC to
proceed with the nomination.
• Emaar NOC has to be obtained in order to enable the submission of LV
drawings to DEWA. The Renewal of design NOC can't be obtained without
Emaar NOC.
8
Area of Concerns
Area of Concern & Impact if Action not made
1
2
3
4
5
6
7
8
9
10
Lack of proposal for a permanent solution to the diphragm wall:
Impact: Prolongation for the work suspension in Zone B.
Lack of MEP's IFC revised drawings from Ramboll from level 43
and above:
Impact: Delay in relevant shop drawings and thus delays to obtain
DEWA approval for the shop drawings /schedule of loads and
delays in procuring LV panels and Bus bars.
Lack of Façade and Lifts detailed activities in the target
completion schedule:
Impact: Prevents AECOM from identifying the Façade and Lifts
critical activities for the project delivery. Also prevents AECOM
from closely monitoring the progress at site.
Monthly Progress Report No. 7 - September 2014
Required Date
10.Okt.14
15.Okt.14 DAMAC/Ramboll
30.Okt.14 Arabtec
30.Okt.14
Lack of manpower for MEP work:
Impact: REMCO will not be able to give ATC the MEP clearance to
start the block and plaster works on time as per TCP-rev 3. 01.Okt.14
Absence of an independent inspection agency for post tension
installation:
Impact: The quality of PT works may be affected. Currently ATC is
not in compliance with the specifications and payment deductions
will be applied in response.
30.Okt.14
Delay in submitting fabrication drawings and shop drawings for
the secondry steel structure at level P5:
Impact: Installation of Unitized Curtain Wall will be delayed.
Delay in the installation of façade glass panels (Stick&Unitized):
Impact: Potential delays to the suspended ceiling installation.
01.Okt.14
8 days Core Wall cycle will not be achieved in level 62 :
Impact: Potential delays to structure completion date as the
structure is on the critical bath.
Responsible Impact
AECOM/DAMAC
15.Okt.14
Arabtec
ATC/ALICO
C
C
C
C
Arabtec C
ATC/REMCO
Arabtec

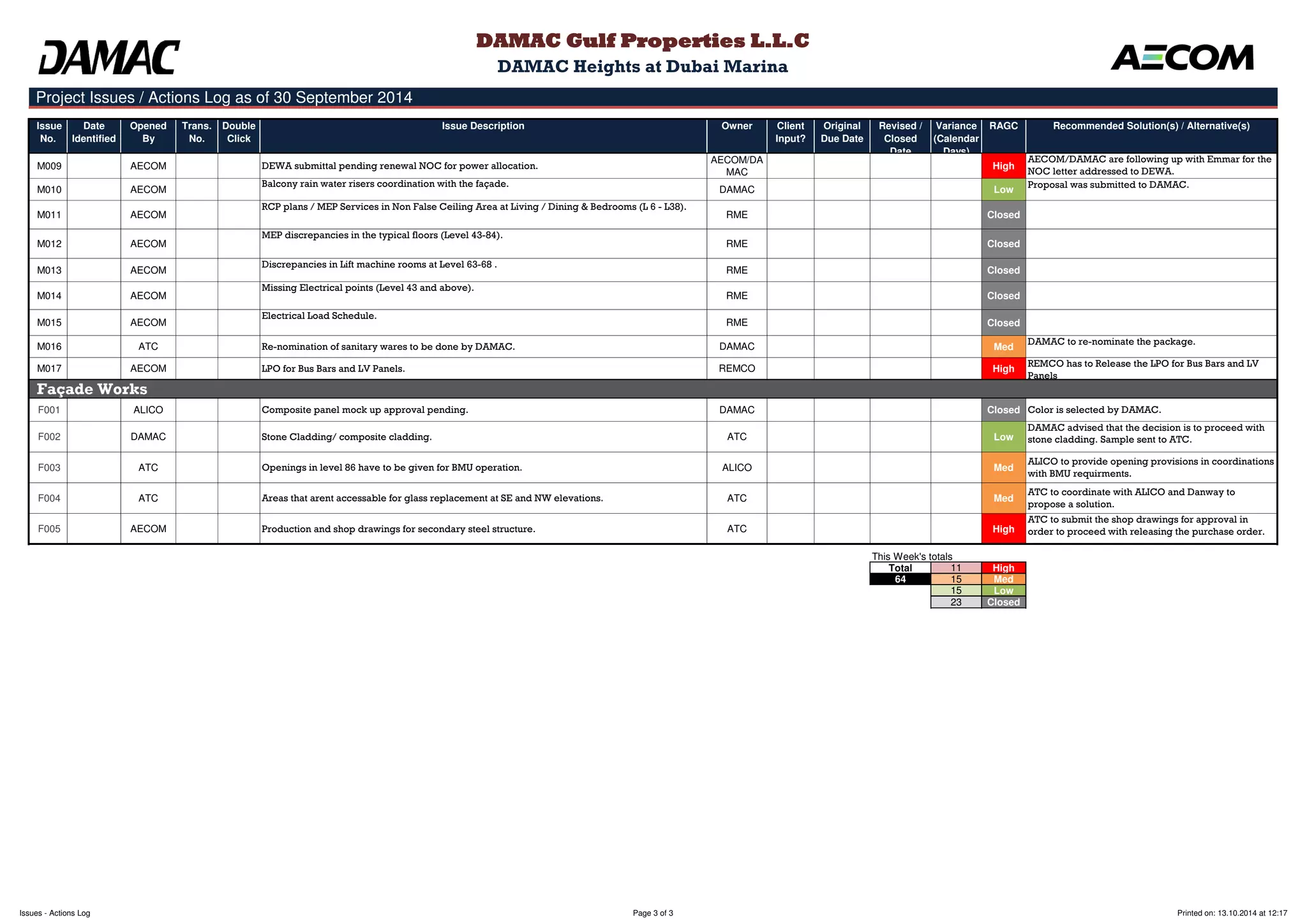

Lack of de-strutting sequencing in Zone B :
Impact: Potential delays to the excavation work. 10.Okt.14 AECOM
Delay in finishes and electrical works inside the substation:
Impact: Potential delays for handing over the substation to DEWA
and delay for the permenent power application. 01.Okt.14 ATC
C
C
M
M
M
9
Area of Concerns
Monthly Progress Report No. 7 - September 2014
Area of Concern & Impact if Action not made Required Date Responsible Impact

11
Critical Manageable
Lack of instruction to proceed with ordering the marble for Lift
Lobby:
Impact: Possibility of installation delays.
15.Okt.14 DAMAC
M
C M
10
Contract Summary
Performance Indicators Measure This Month Last Month
CV EV - AC
EAC Variance EAC - CP
Near Misses 3
* Note: 1) The Cost and Procurement sections will be frozen till
approving the Target Completion Programme.
2) SPI and SV improved due to the issuing of TCP-Rev 03.
Approved
Claims
Approved PS
0 2 26,116,726
No. of Near Misses
Schedule Progress %
Total
Commitments
479,041,833
Variation Status
Variation Approved
35
Financial Status (AED)
Approved
Variations
Upward Trend Downward Trend No Change
Residual PS Pending
Effective
Contract Value
Gross Certified Physical %
AED % AED % AED % AED %
119.845 23.6% 115.38 22.7% 75.44487 14.84% 63.693 12.5%
Complete
Variations
AC - Actual Cost; CPI - Cost Performance Index; CP - Contract Price; CV - Cost Variance; EAC - Estimate At Completion; EV - Earned Value;
NCR - Non-Conformance Report; PV - Planned Value; RFI - Request For Information; SPI - Schedule Performance Index; SV - Schedule Variance
79
* Note: The percentage value is the current amount divided by the Contract Price
of AED 508,301,847.
Monthly Progress Report No. 7 - September 2014
22.46%
Payment Status (AED m)
9 9 26
0.85
-56.5
-157
Area
Time
SPI EV / PV
SV
Float (MS01)
0.89
-44.8
-182
EV - PV (AED m)
Days Float
Remaining
CPI EV / AC
NCR Close Out Issued/Closed
98/85 92/77
RFI
Submittals
% Closed 88%
86%
90%
88%
Cost
Quality
Health and
Safety
Engineering
244,747,598
Variation Under DAMAC
Assessment
Variation Under
ATC Assessment
Total
Procurement Major Items
Variation Rejected
2
% Closed
Gross and Net certified figures exclude Advance Payments.
Estimate at
Completion
8,177,509 5 18,378,571
Net Certified Perviously Certified Paid to Date
37,437,524 1,899,214
11
Control Milestones
Days
Monthly Progress Report No. 7 - September 2014
Milestones TCP-Rev 3 Current Forecast Current Float
Remaining
Clause 14
Program
592 18-Jun-14
226 08.Aug.13
159 06.Mär.13
90%
34%
5%

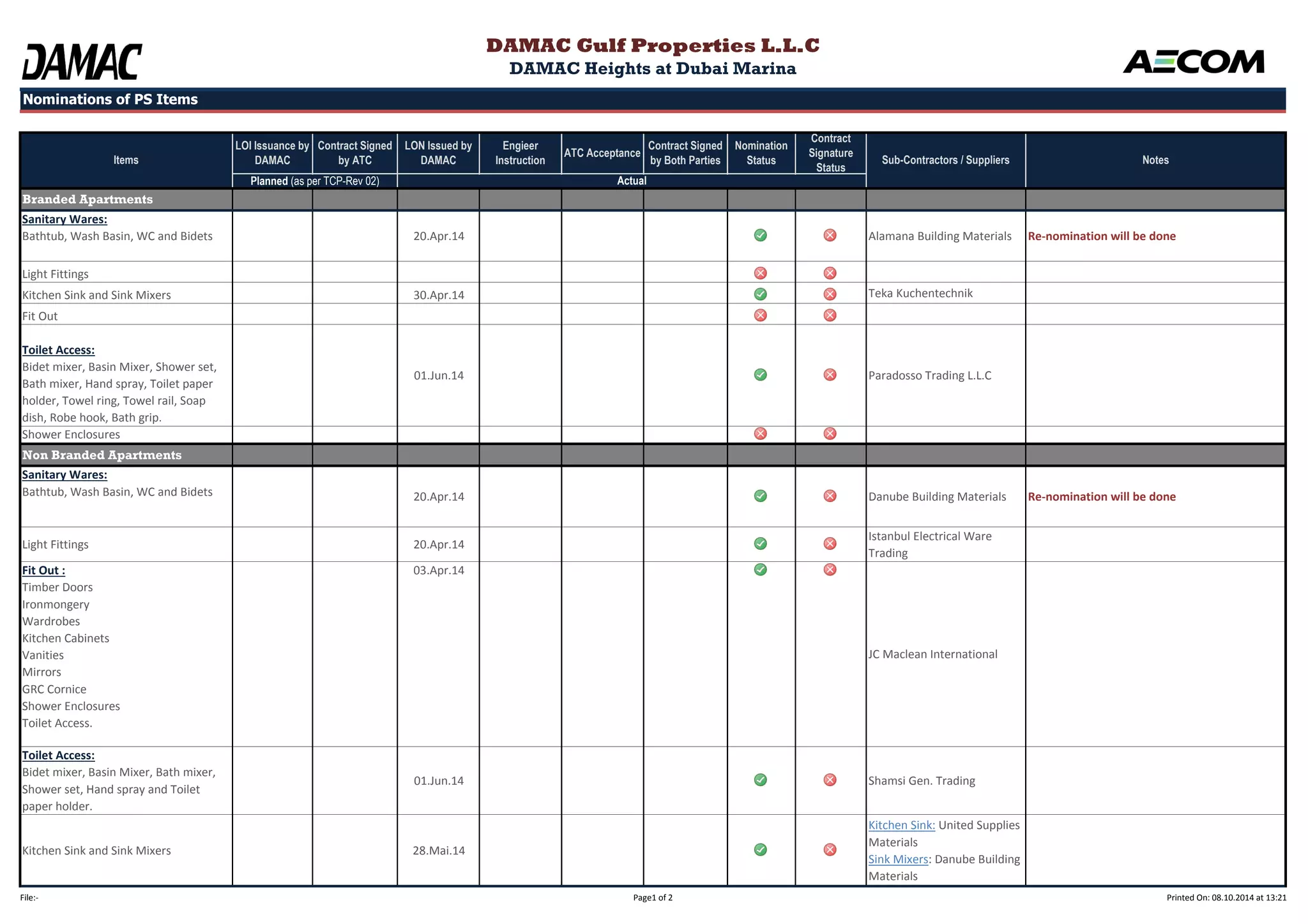

Nomination of PS Items (not yet nominated)
Days
> 5 days
0 to 5 days
< 0 days
Upward
Trend
Downward
Trend
Milestones TCP - Rev 3 Current Forecast Current Float
Remaining
Clause 14
Program
-218 2-Feb-12 10
-41 3-Jun-12 80
51 21-Nov-12
35 4-Mar-13 80
44 80
-27 17-Apr-13 80
90%
34%
5%
30.Sep
Permits/NOCs Status Summary
Actual
Issue Date
23-Jan-11
14.Nov.13
25.Nov.13
10.Jul.14
171
SC Nomination for Fit
Out (Fendi Flat)
SC Nomination for
Sauna,Jacuzzi
13-Nov-14 13-Nov-14
3-Sep-14 1-Oct-14
Revised
Appoval
Required
- 30.00
3.00
50.00
Variance
since Aug 14
(30.00)
RME/AECOM
FIC Location Approval RME/AECOM
Dubai Municipality
Fence NOC RME
SC Nomination for Fit
Out (Life Style)
4-Nov-14 4-Nov-14 116 0.00
SC Nomination for
Landscaping Works
20-Nov-14 Nominated
SC Nomination for
Swimming Pool Works
20-Aug-14 1-Oct-14 69 (30.00)
20
Ground water Discharge 08.Mai.14
Drainage Design NOC
and Drawings Approval
ATC
22-Jul-11
Authority NOC/Permit
Anticipated
Issue Date
Expiry Date
Days
Remaining
Responsible
0 to 5 days
< 0 days
Upward
Trend
Downward
Trend
No Change
Note: Days remaining from 30 Sep 2014 to Planned Dates of TCP.
Variance
since Aug 14
MS03 -Producing Wild
Air (till 30th Floor)
8-Mar-15 5-May-15 -50
MS02 -Completion of
Structure
14-May-15 20-May-15 -4
MS01 - Project
Completion
14-May-16 20-Dec-16 -182
0.00
0.00
SC Nomination for
Façade Lighting
24-Feb-14 1-Oct-14 -178
No Change
Note:
1) Days remaining from 30 Sep 2014 to Planned Dates of TCP.
2) Variance since Aug-14: the difference between Current forecast of Sep
vs. forecast of Aug.
> 5 days
12

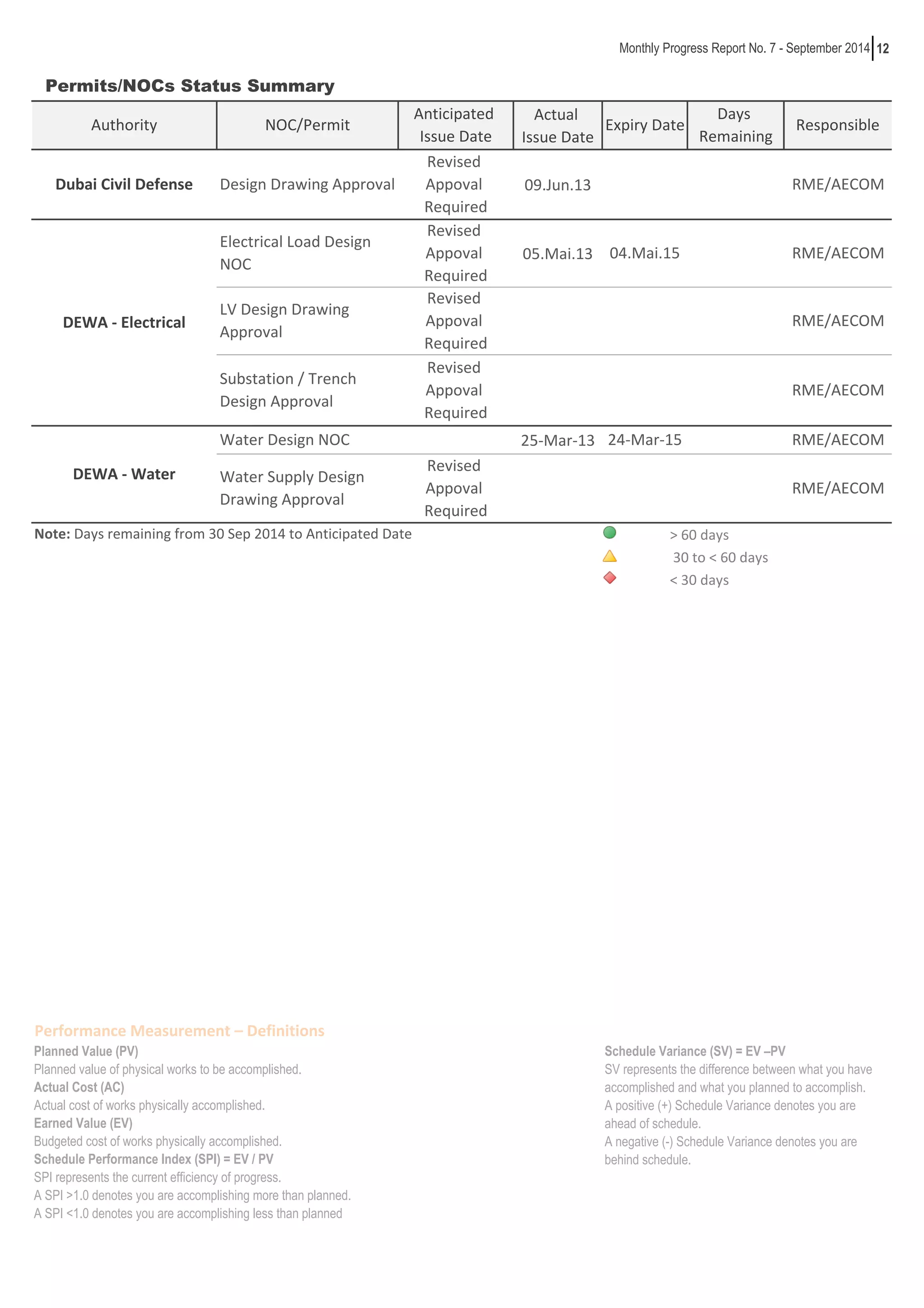

Permits/NOCs Status Summary
Actual
Issue Date
Anticipated
Issue Date
NOC/Permit Responsible
09.Jun.13
05.Mai.13
25-Mar-13
Monthly Progress Report No. 7 - September 2014
Note: Days remaining from 30 Sep 2014 to Anticipated Date > 60 days
90%
34%
5%
PerforŵaŶce MeasureŵeŶt – DefiŶitioŶs
30 to < 60 days
DEWA - Electrical
Electrical Load Design
NOC
04.Mai.15 RME/AECOM
Revised
Appoval
Required
LV Design Drawing
Approval
Revised
Appoval
Required
RME/AECOM
Substation / Trench
Design Approval
RME/AECOM
Planned Value (PV)
Planned value of physical works to be accomplished.
Actual Cost (AC)
Actual cost of works physically accomplished.
Earned Value (EV)
Budgeted cost of works physically accomplished.
Schedule Performance Index (SPI) = EV / PV
SPI represents the current efficiency of progress.
A SPI >1.0 denotes you are accomplishing more than planned.
A SPI <1.0 denotes you are accomplishing less than planned
< 30 days
Schedule Variance (SV) = EV –PV
SV represents the difference between what you have
accomplished and what you planned to accomplish.
A positive (+) Schedule Variance denotes you are
ahead of schedule.
A negative (-) Schedule Variance denotes you are
behind schedule.
DEWA - Water
Water Design NOC 24-Mar-15 RME/AECOM
RME/AECOM
Water Supply Design
Drawing Approval
Revised
Appoval
Required
Authority
Days
Remaining
Expiry Date
Revised
Appoval
Required
Dubai Civil Defense Design Drawing Approval
Revised
Appoval
Required
RME/AECOM
13

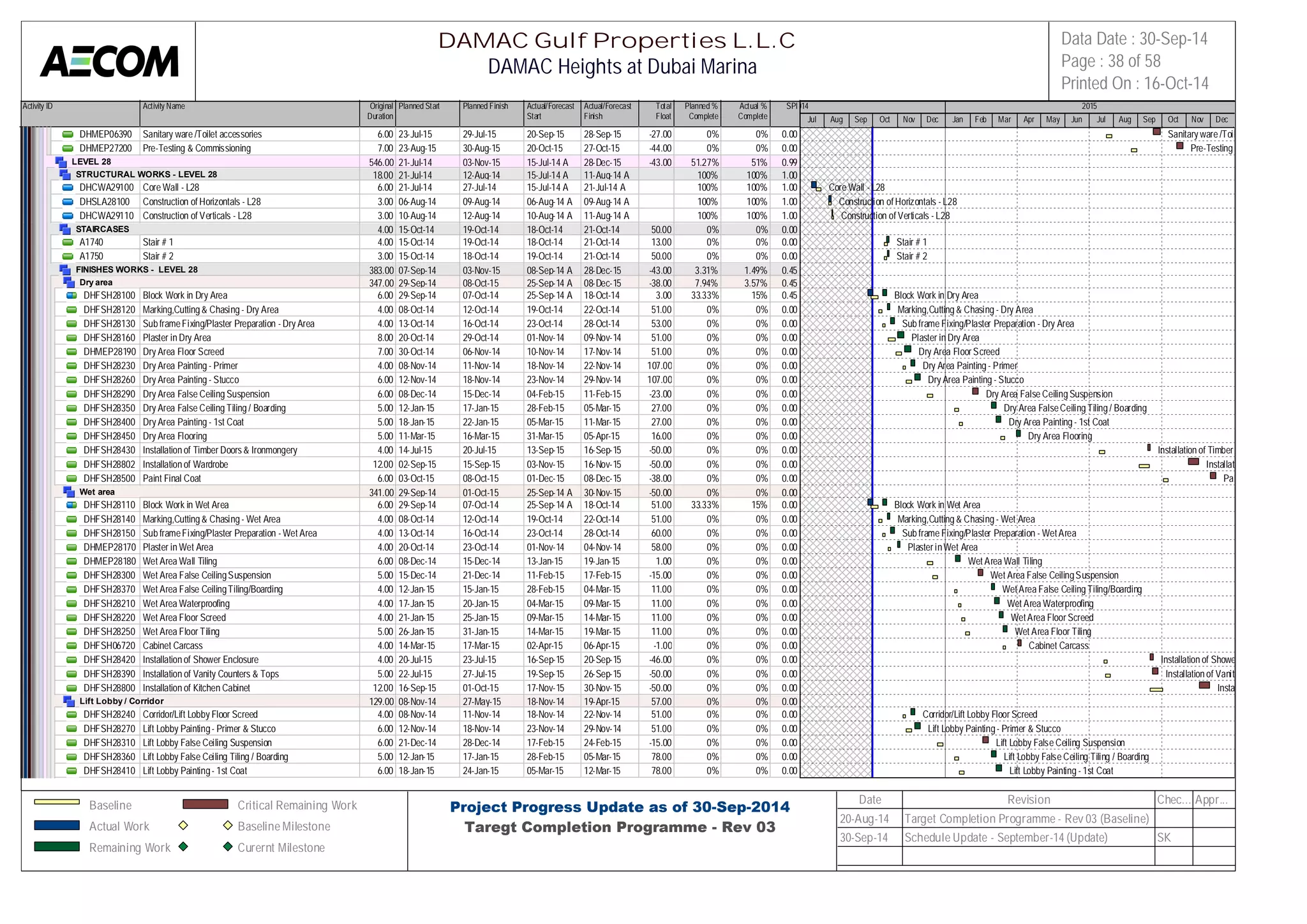

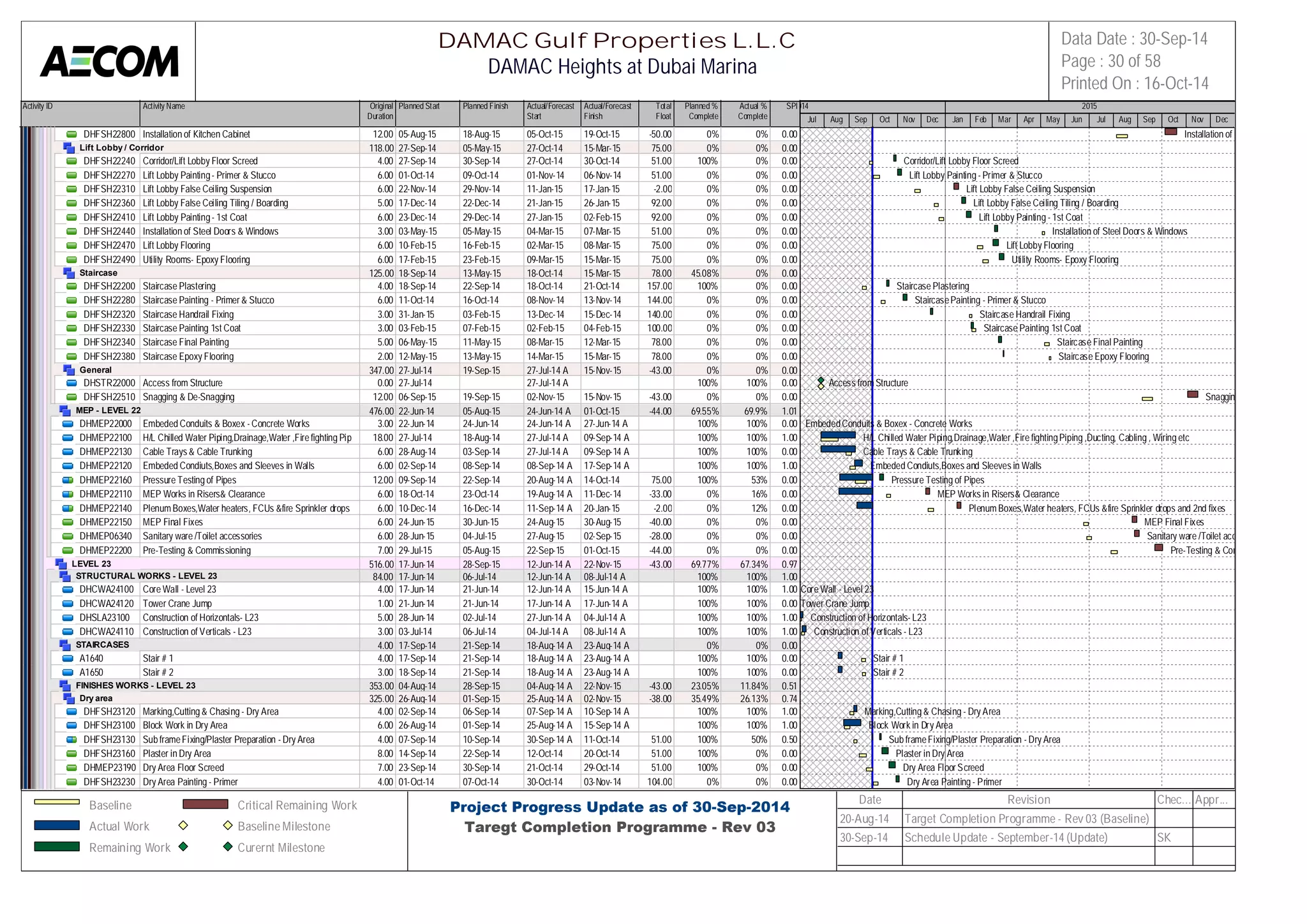

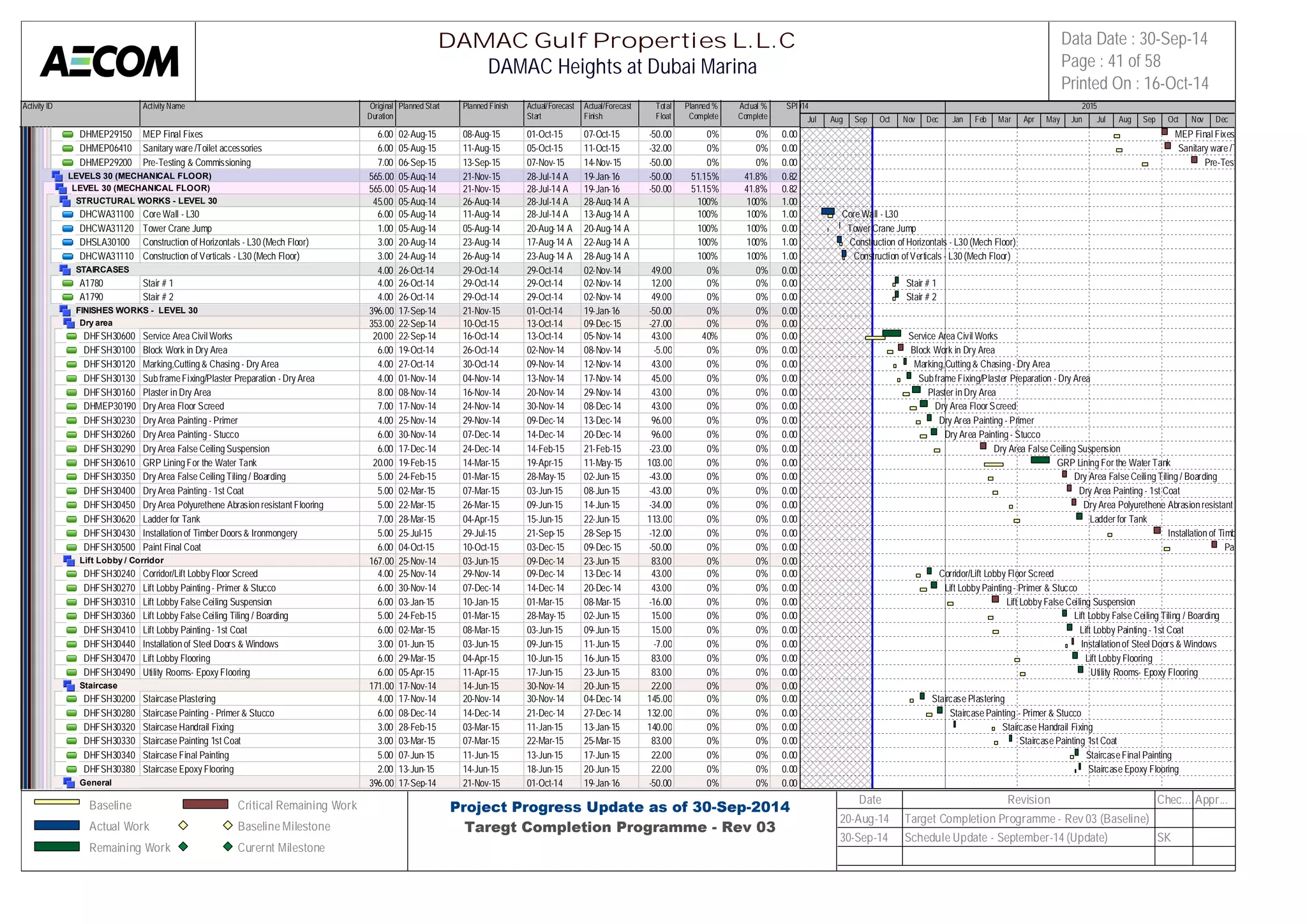

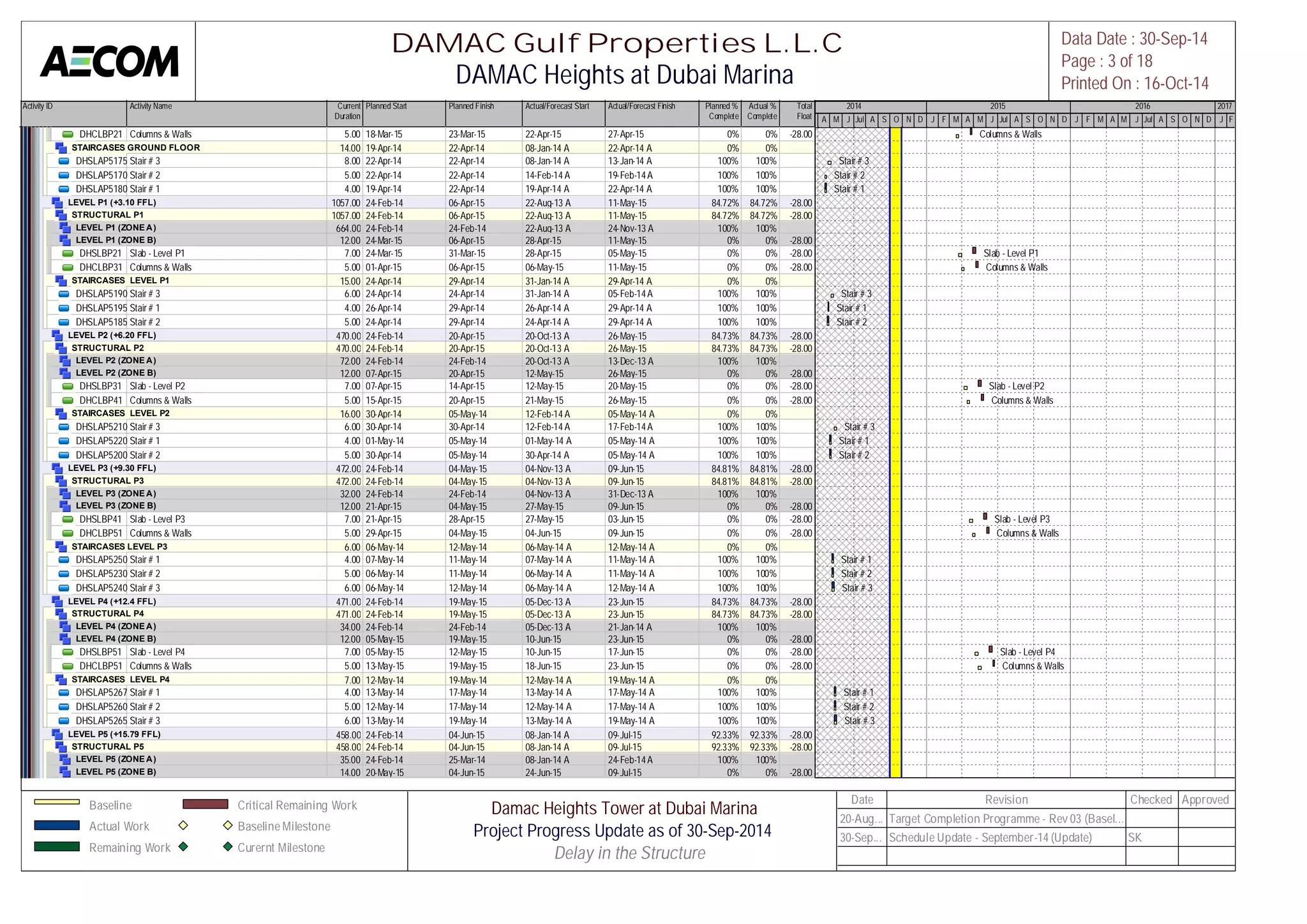

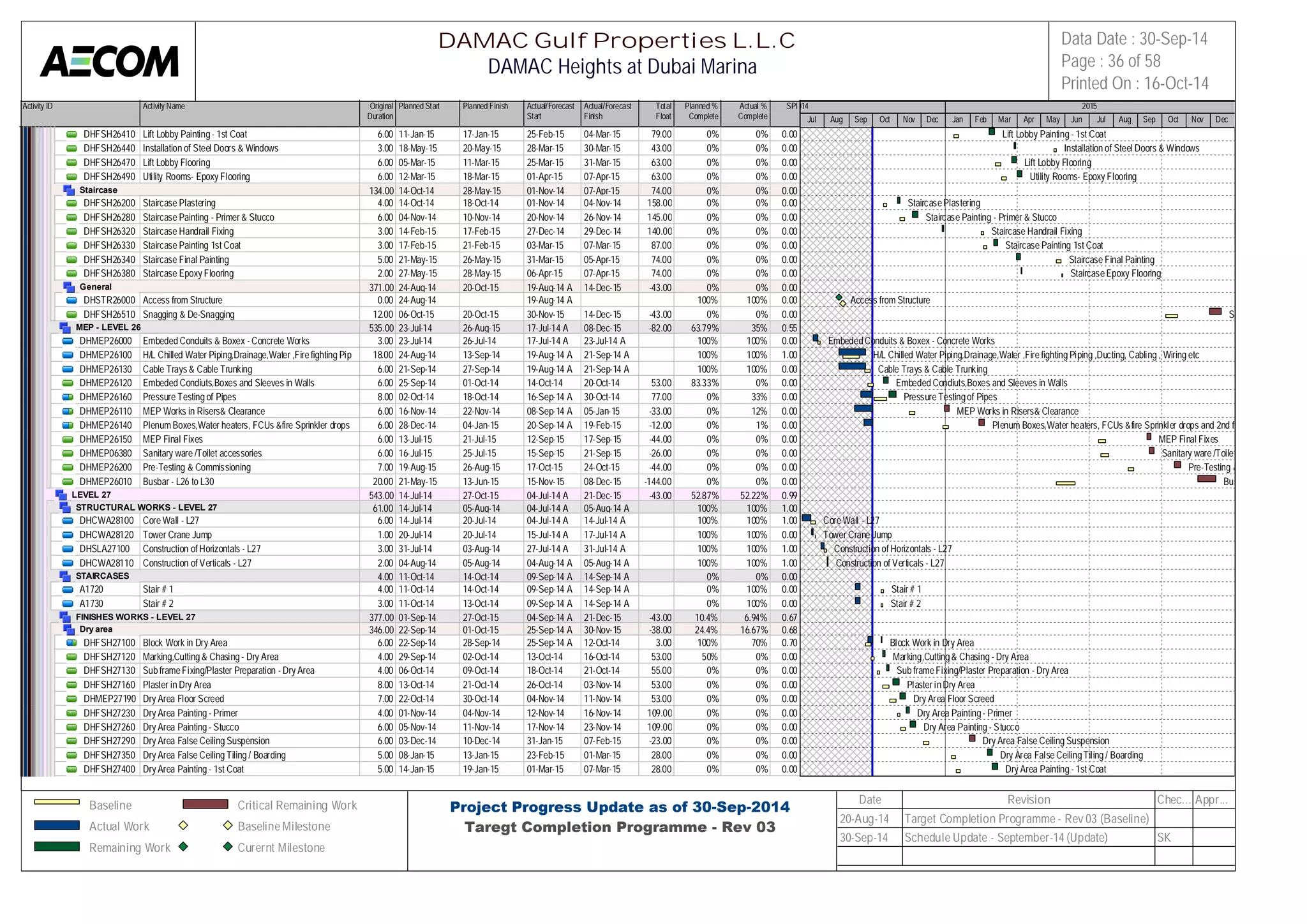

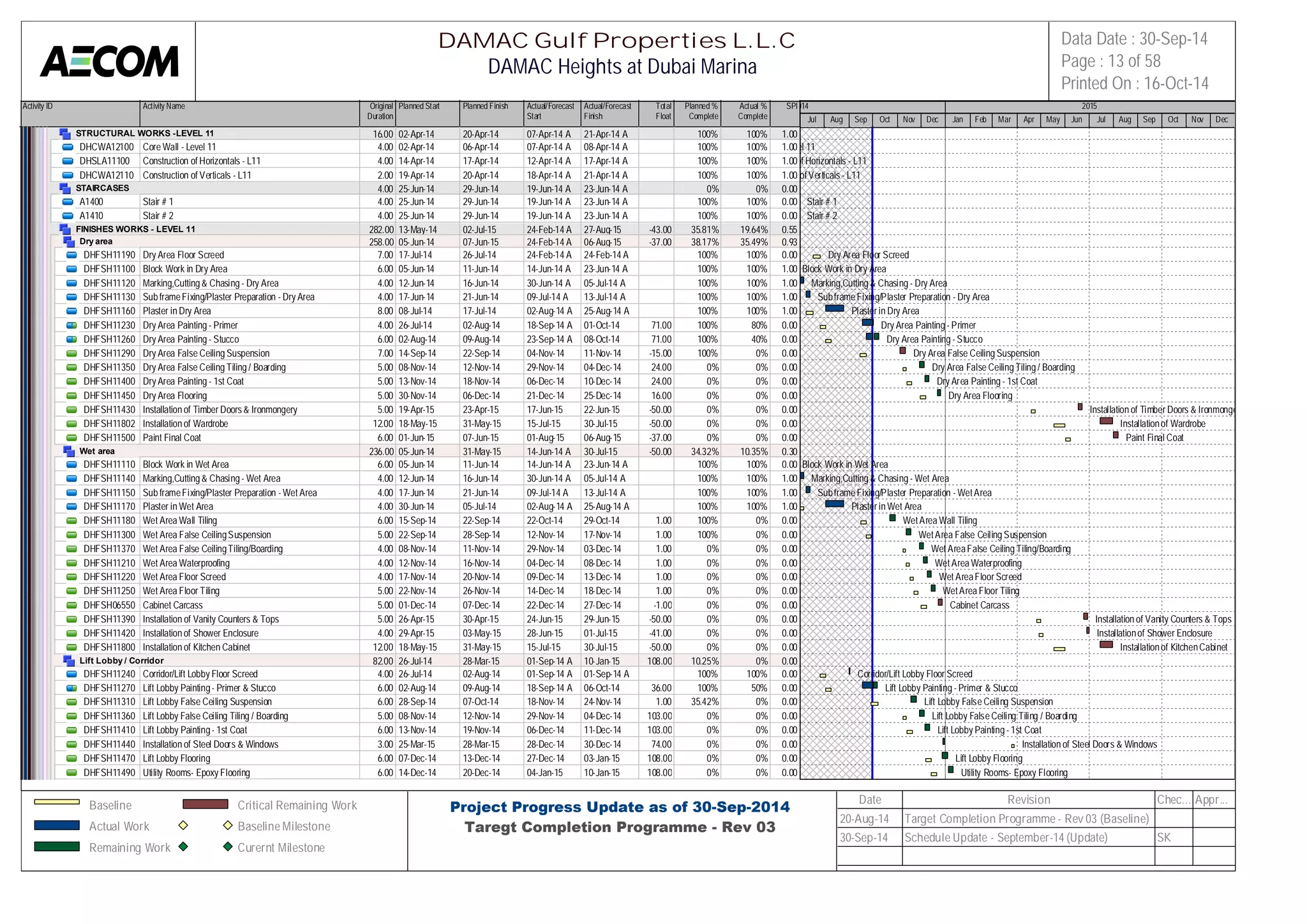

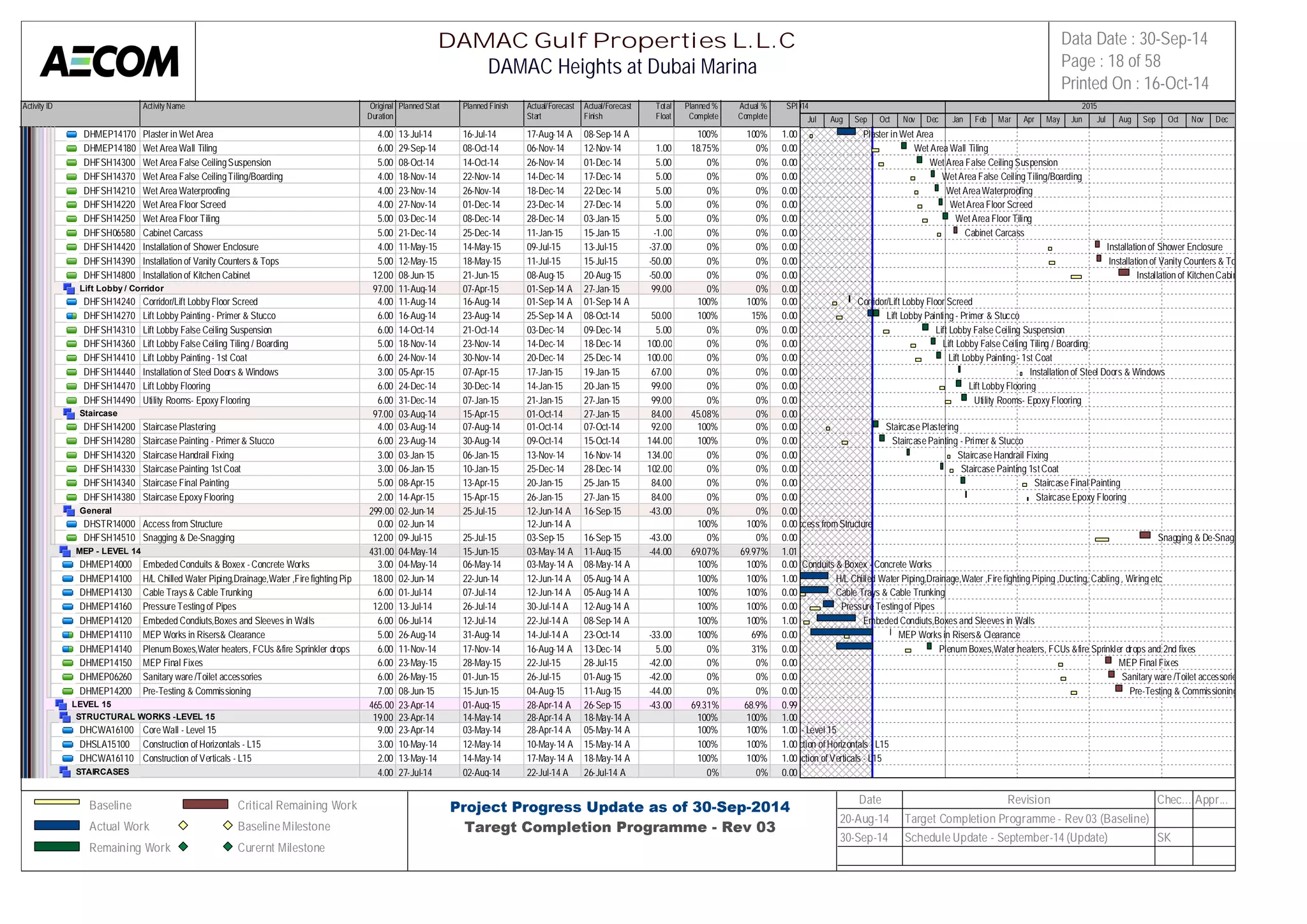

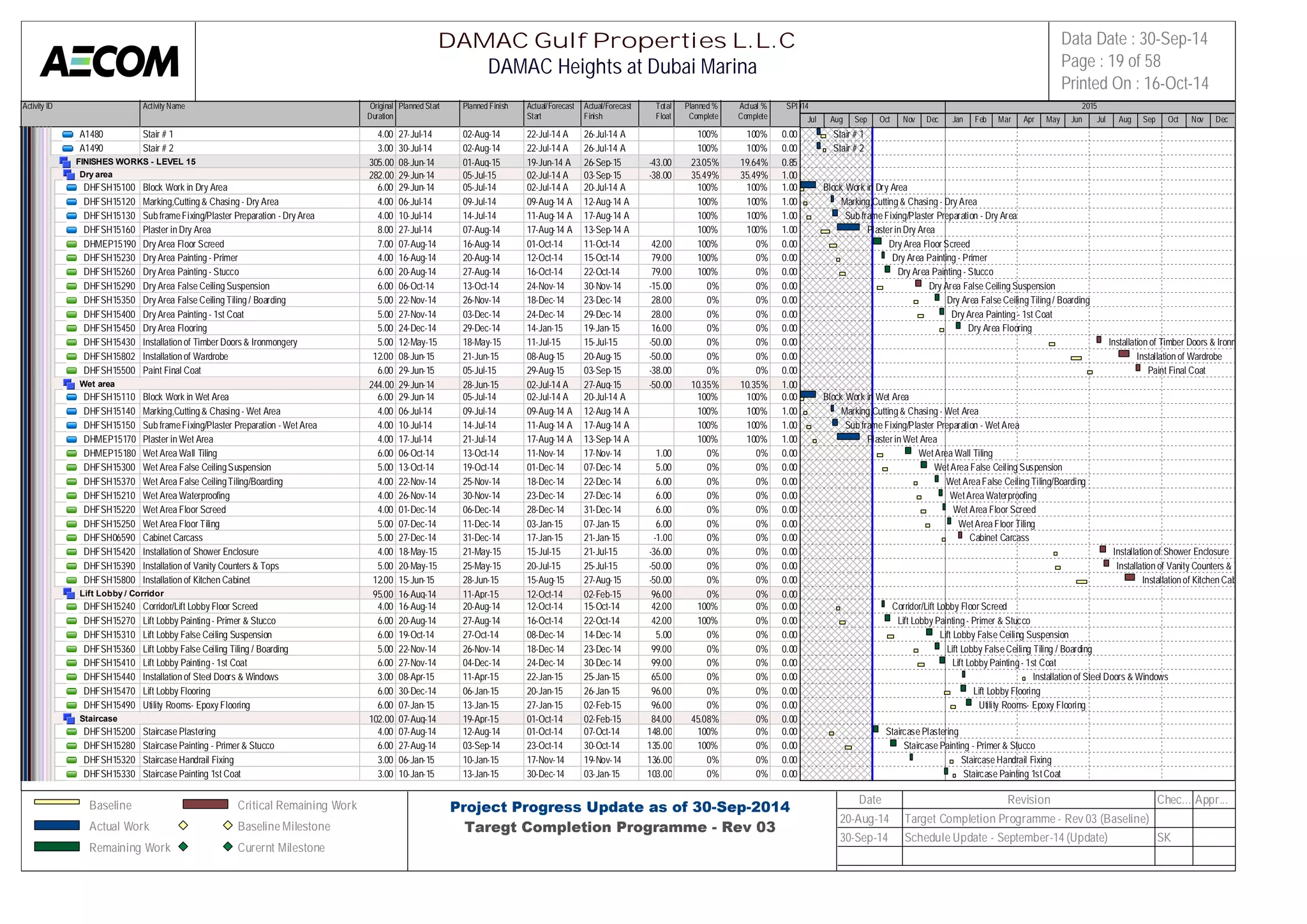

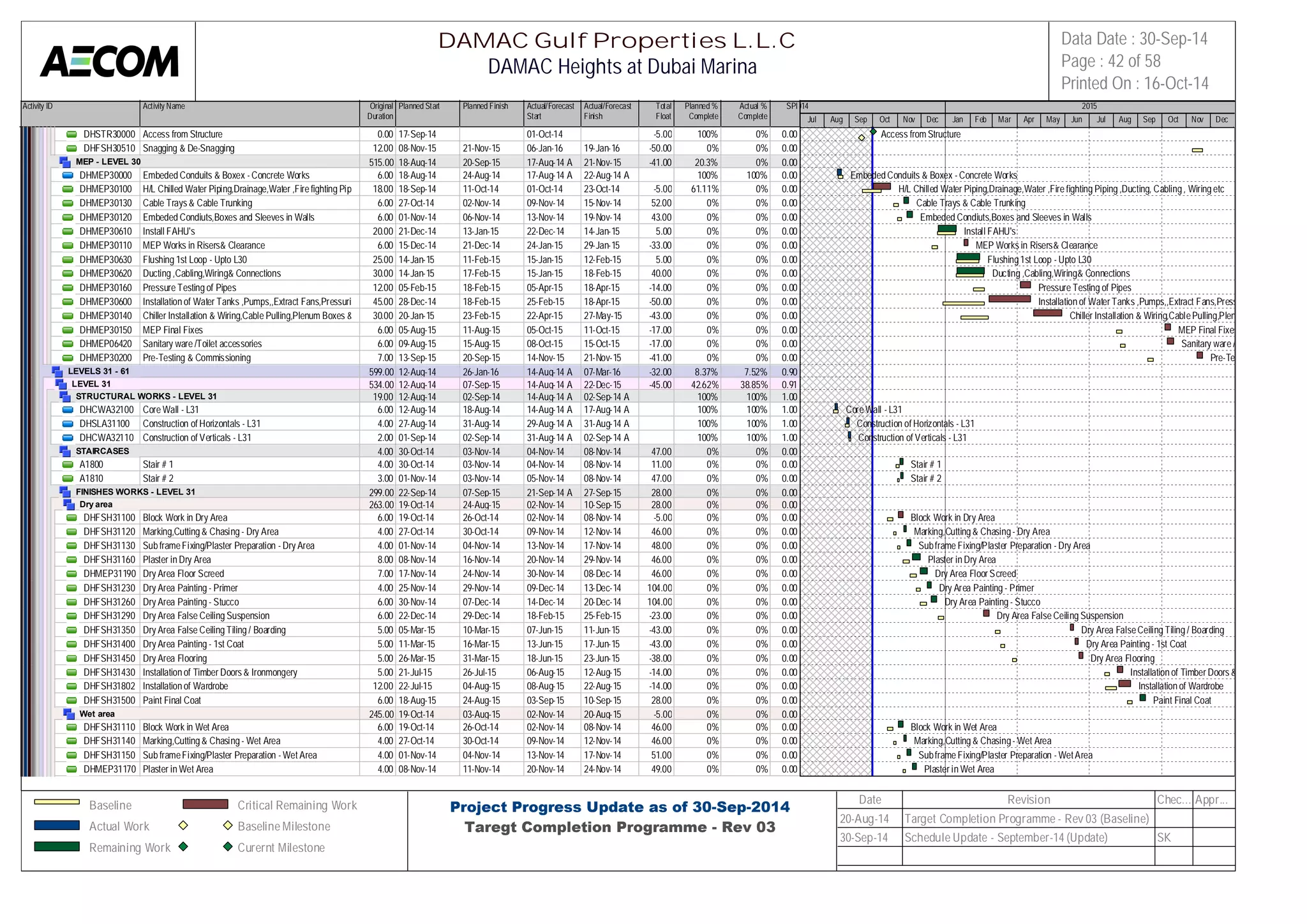

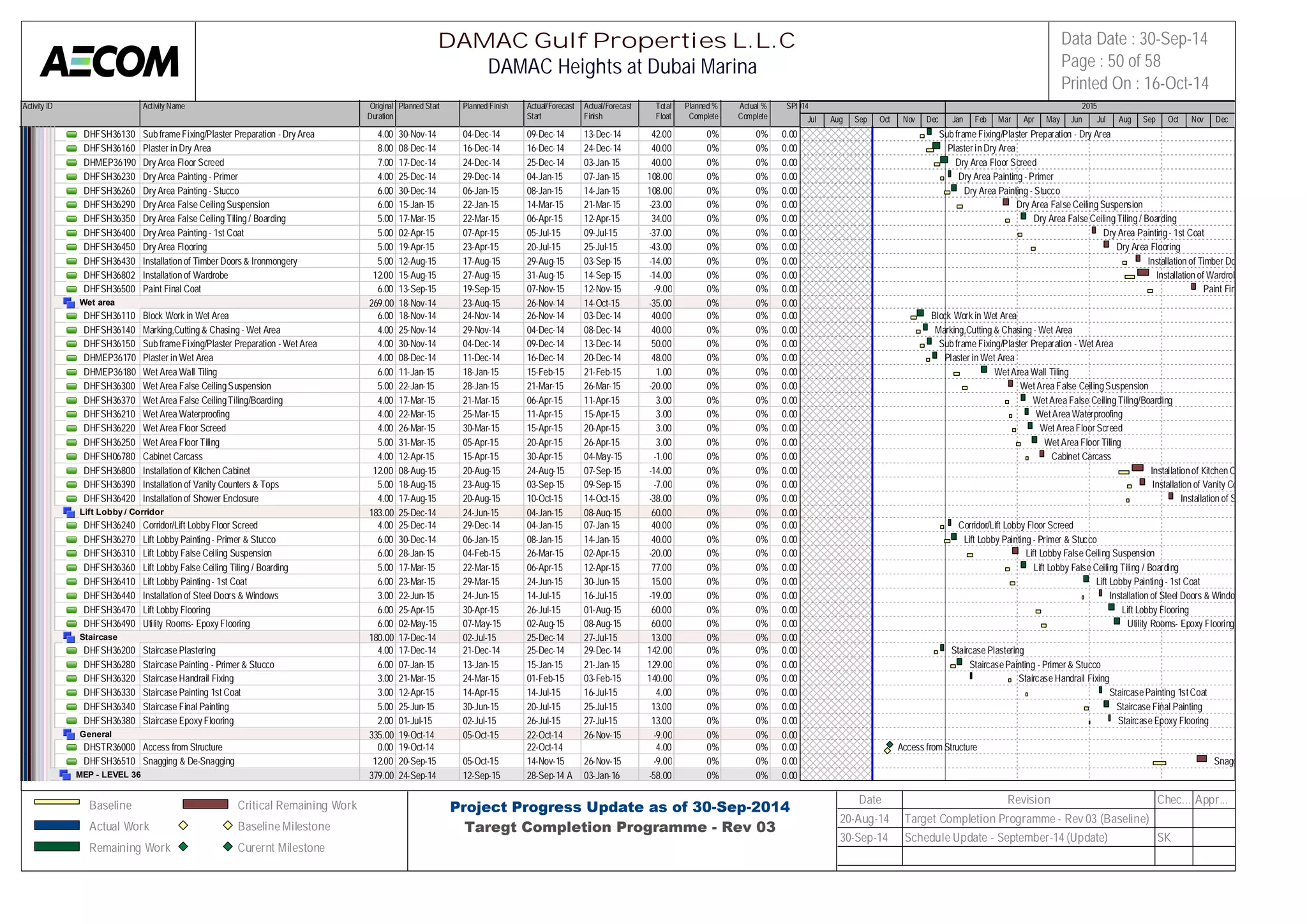

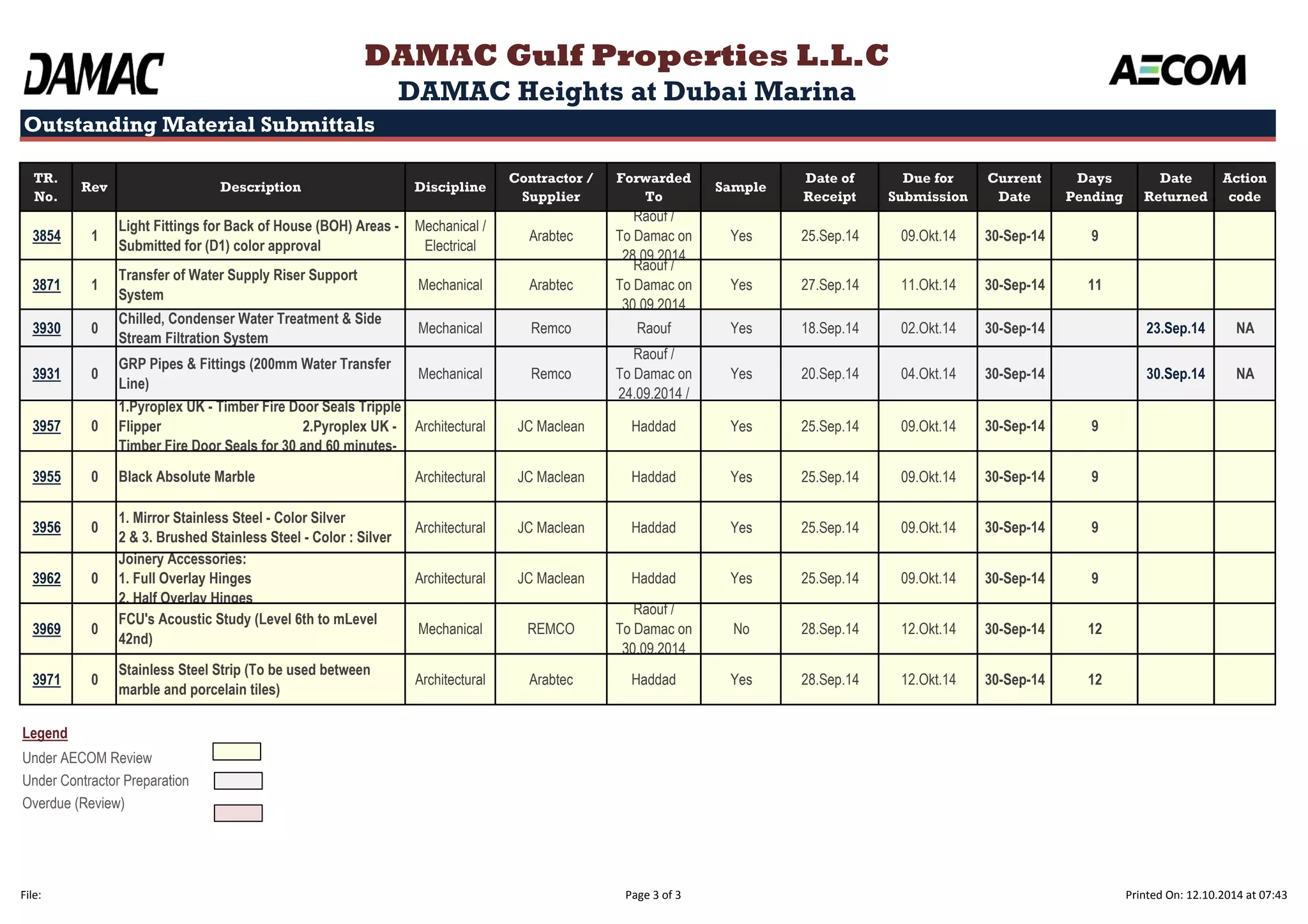

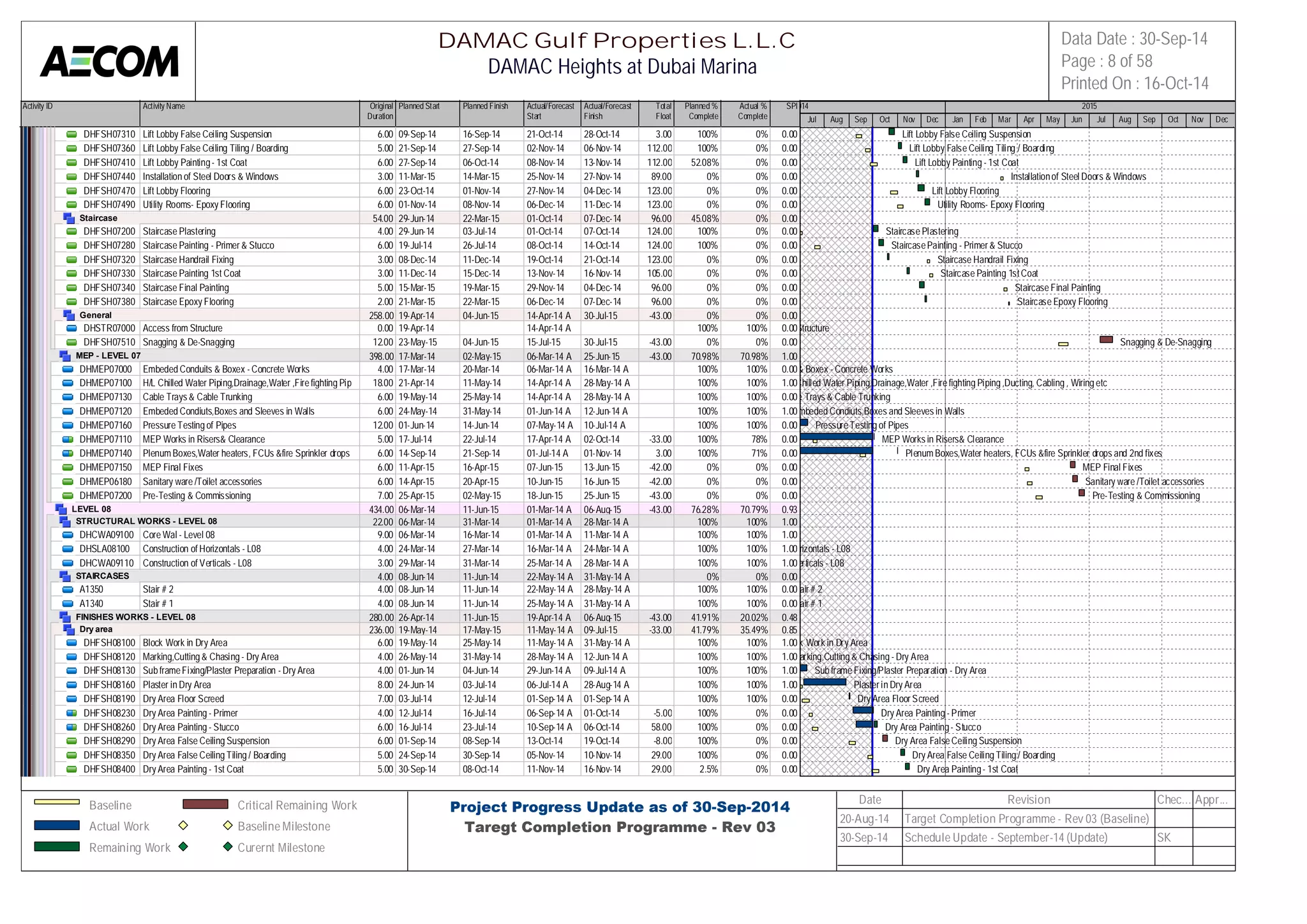

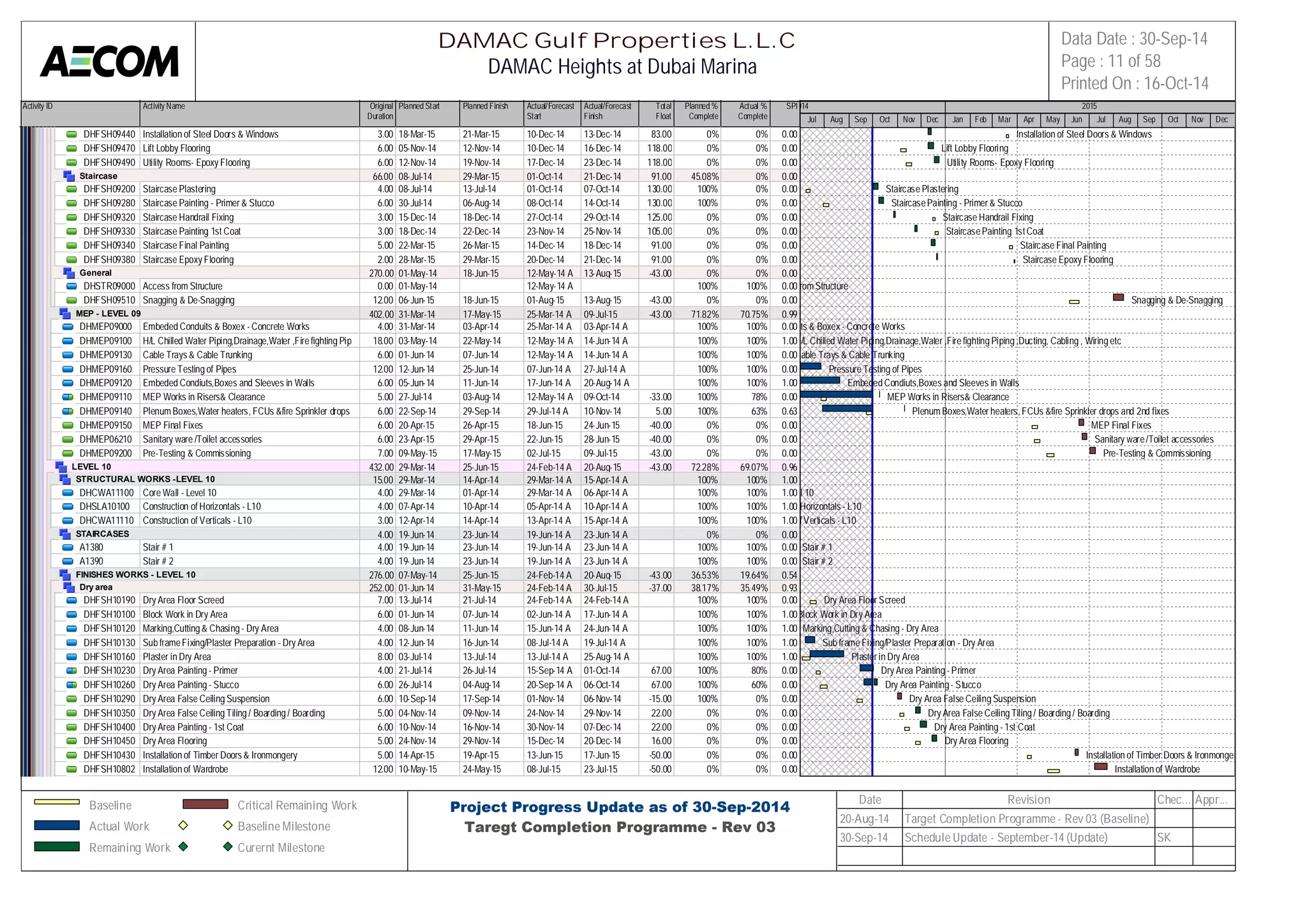

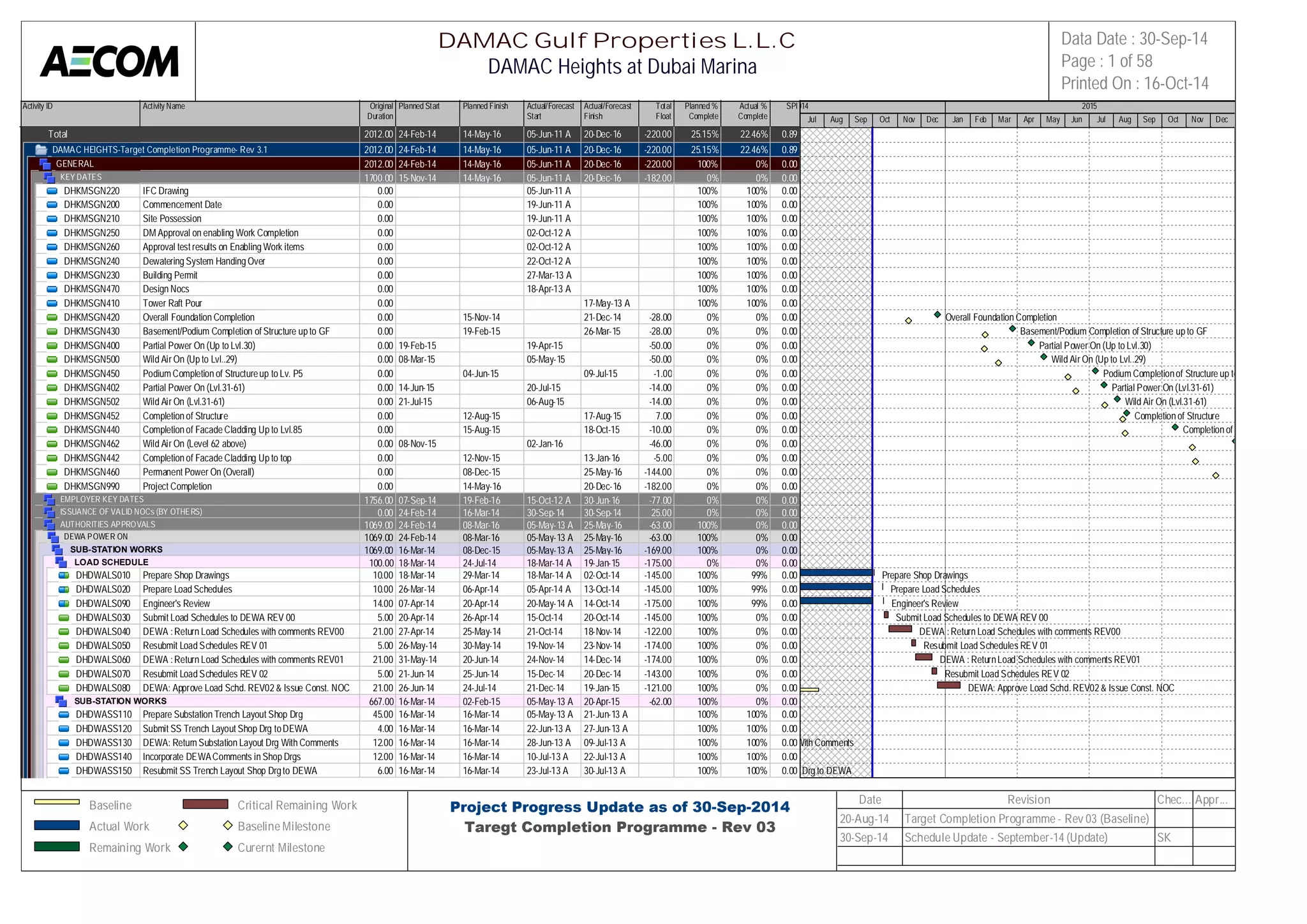

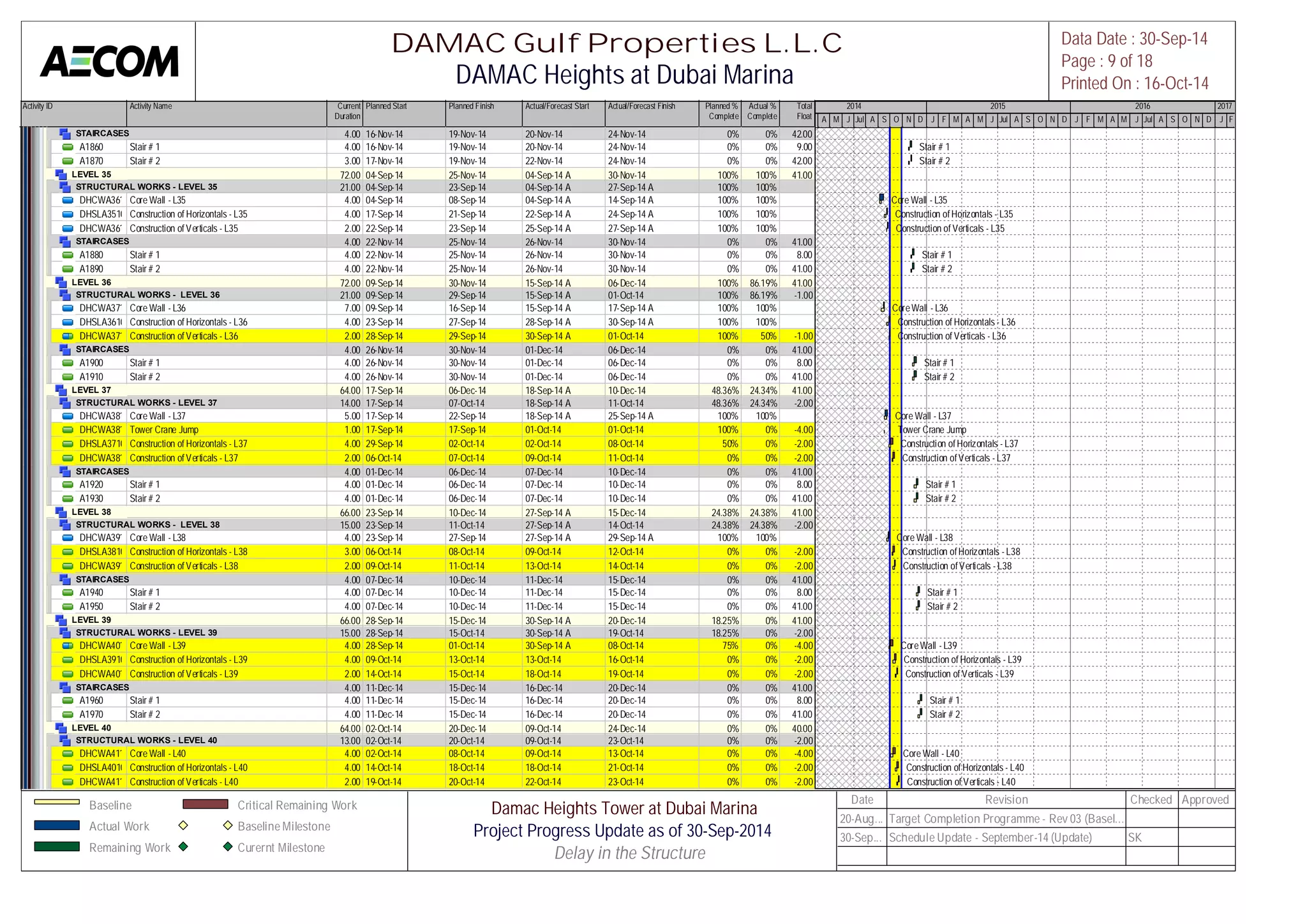

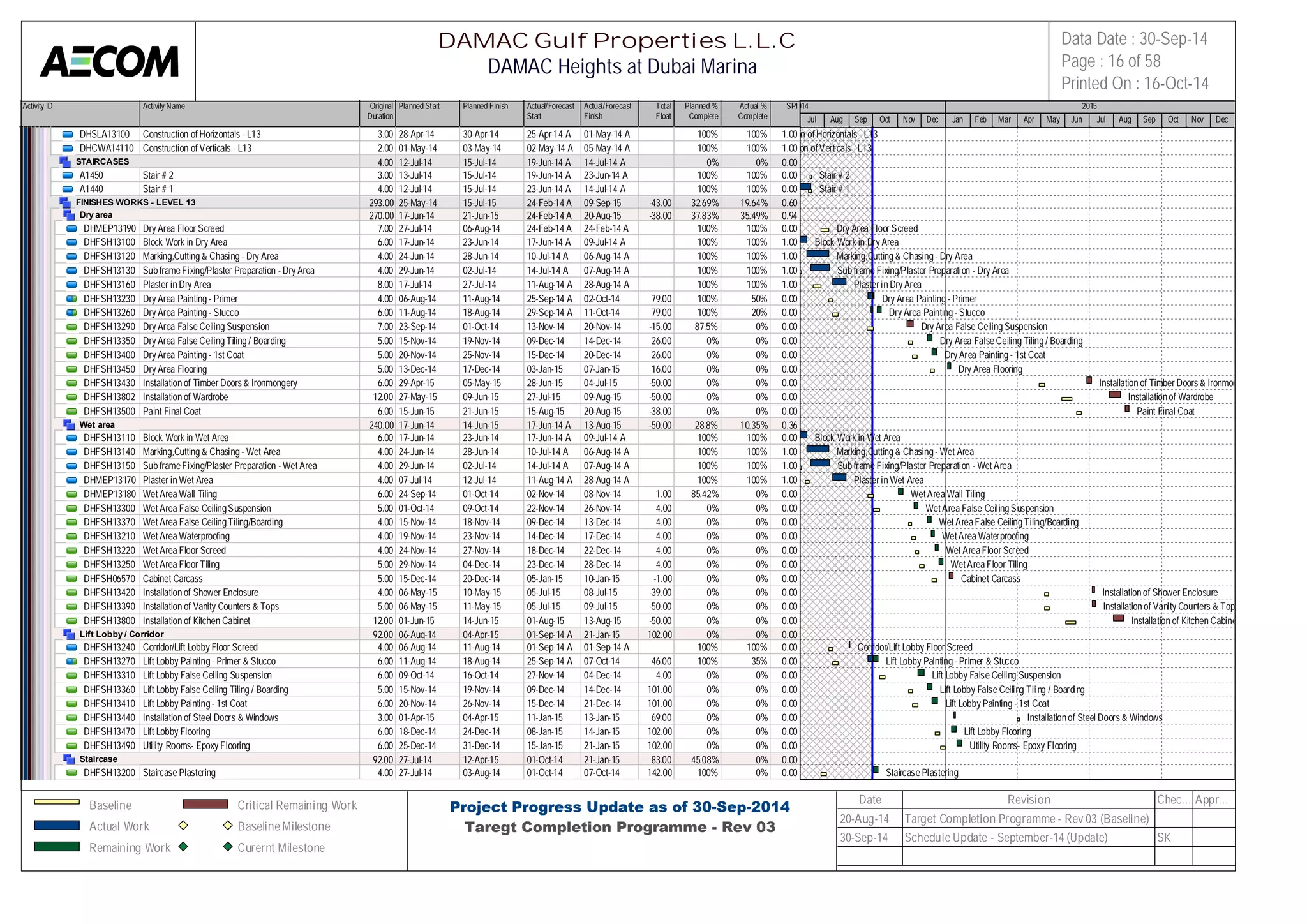

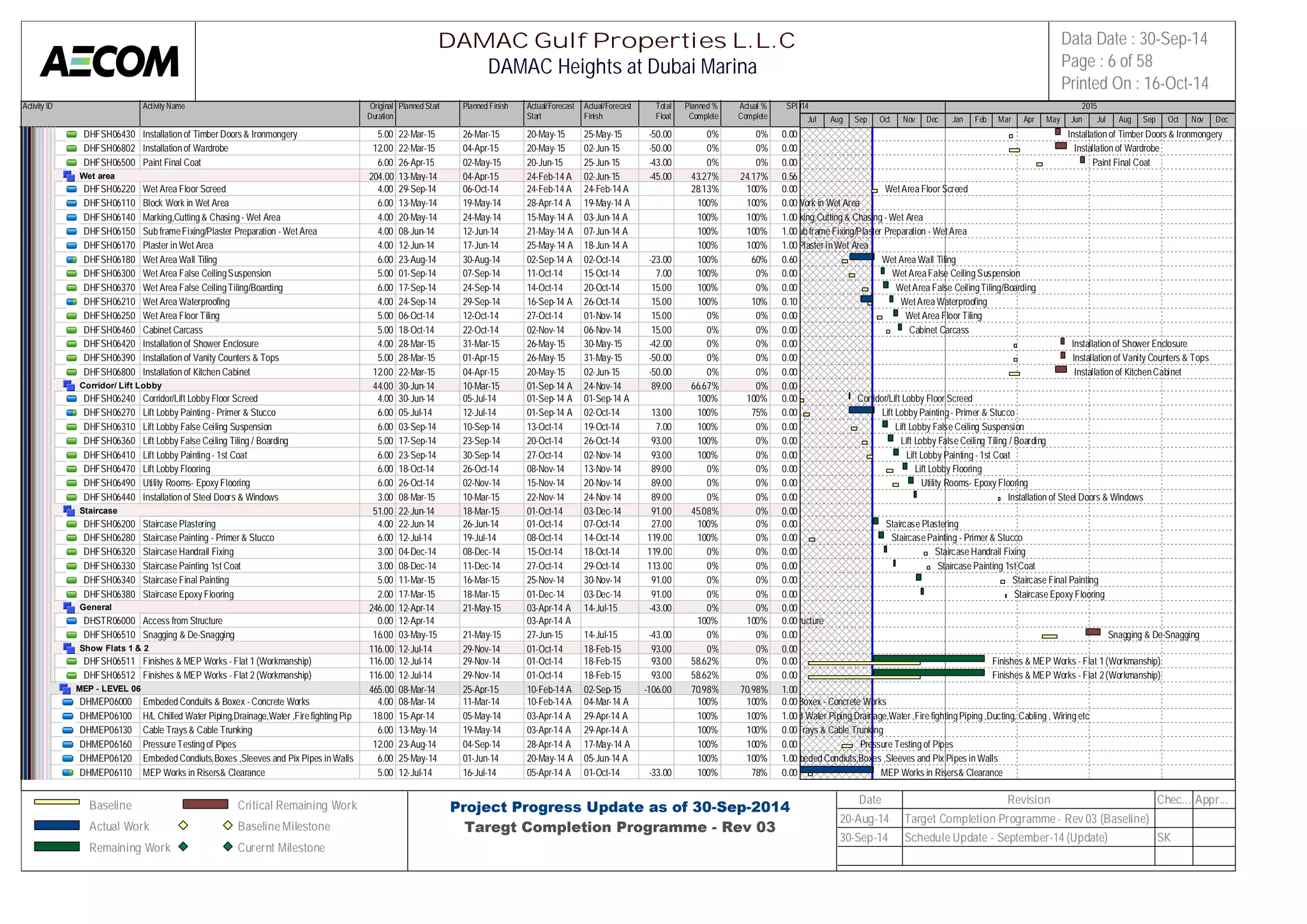

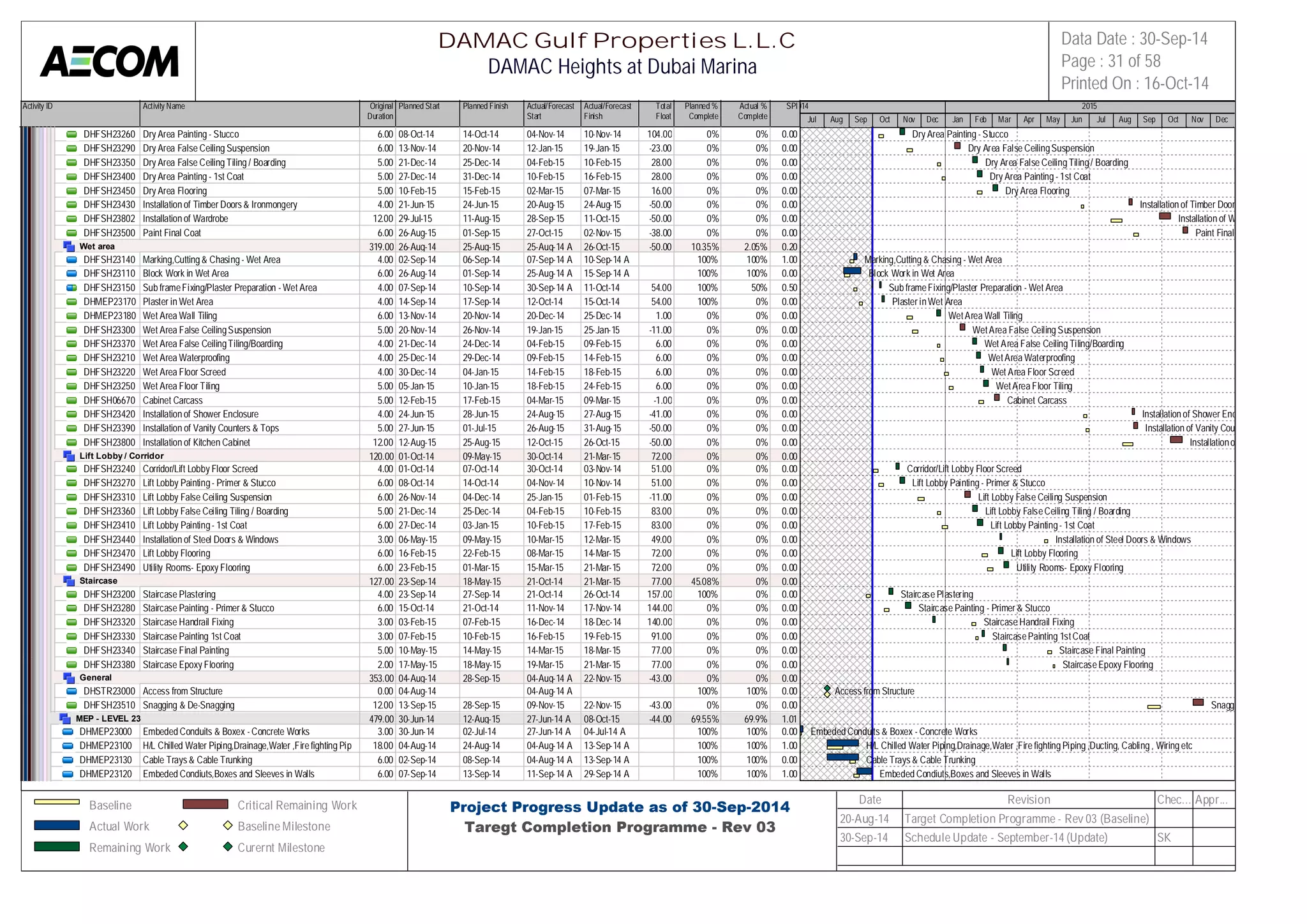

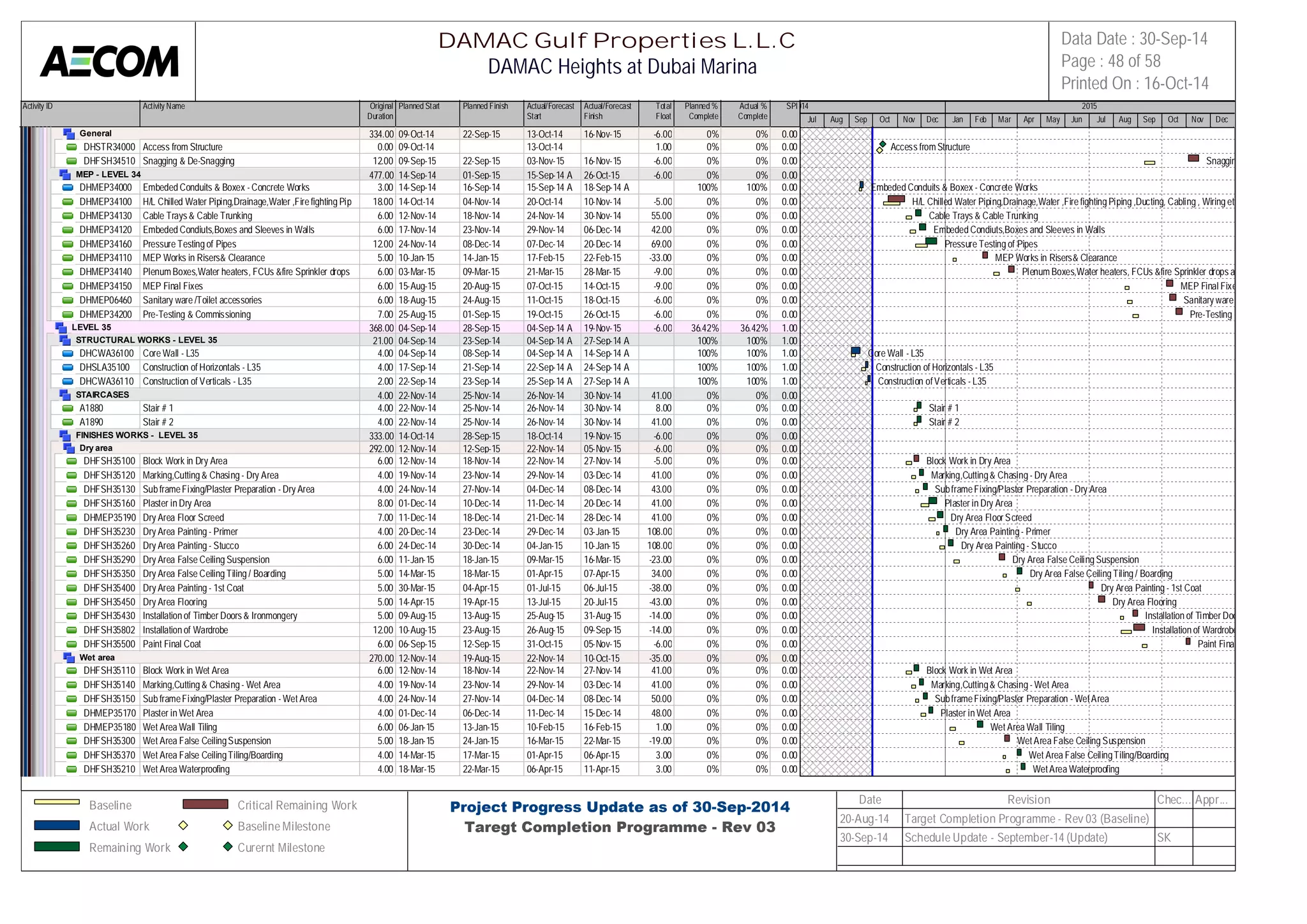

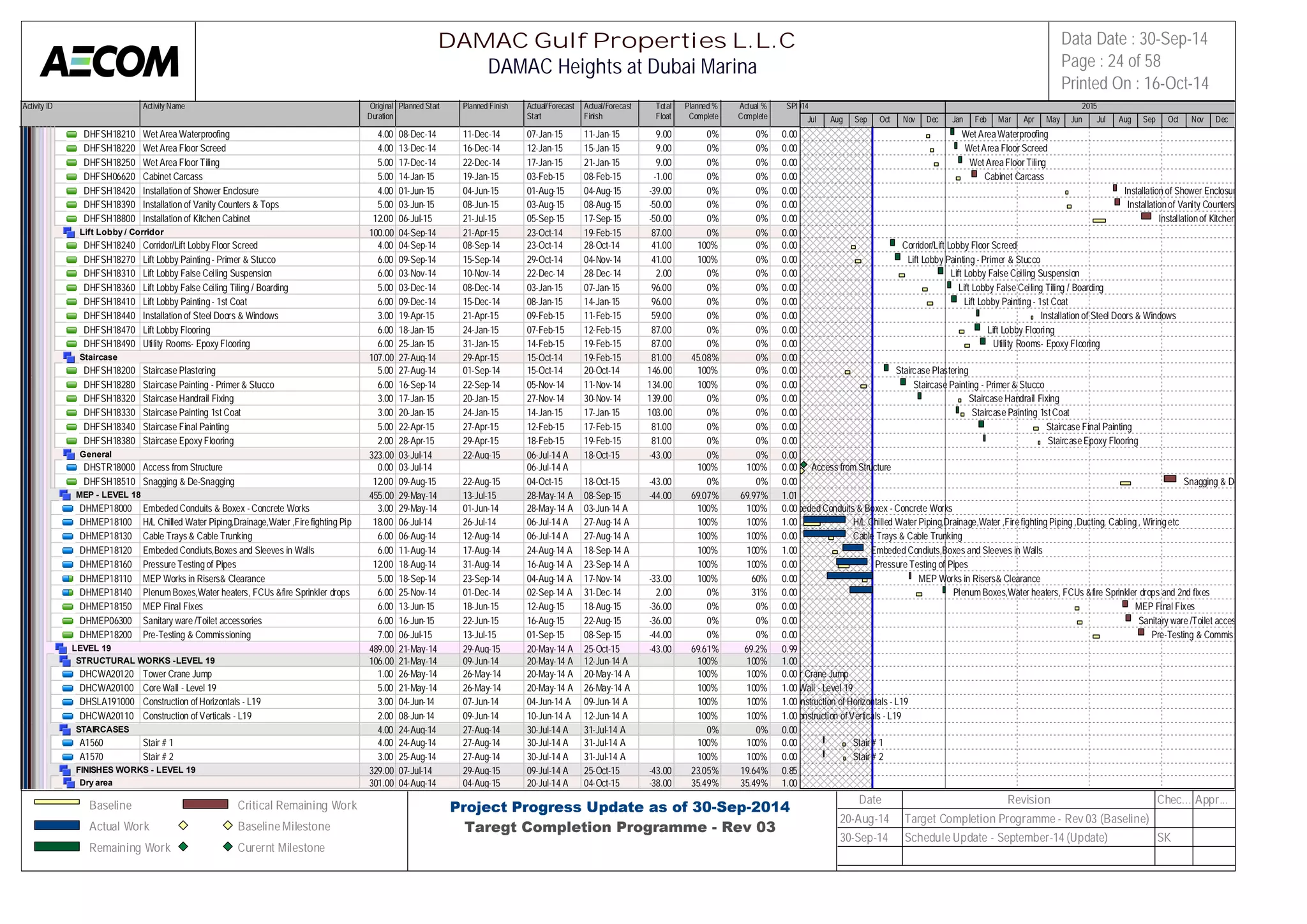

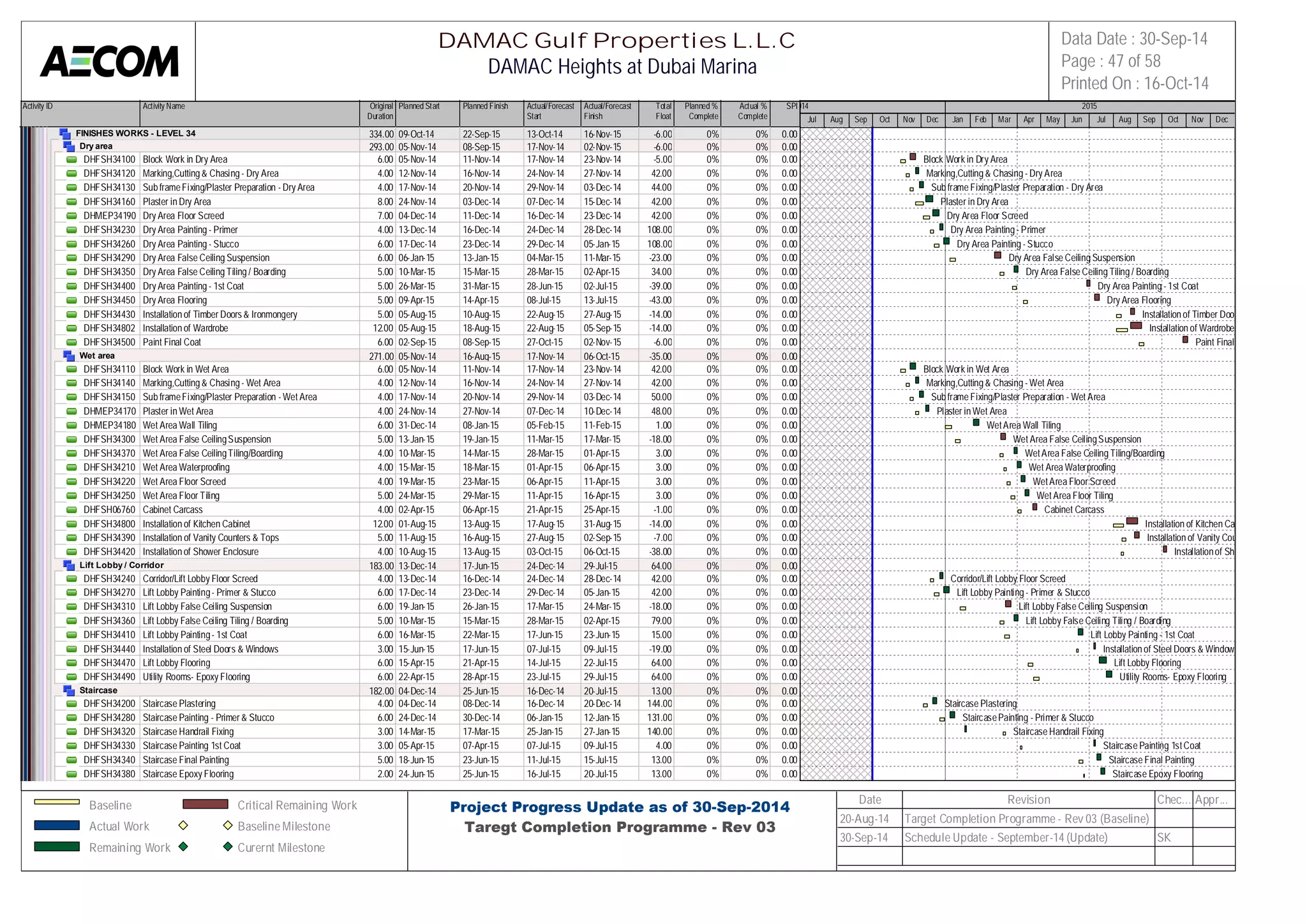

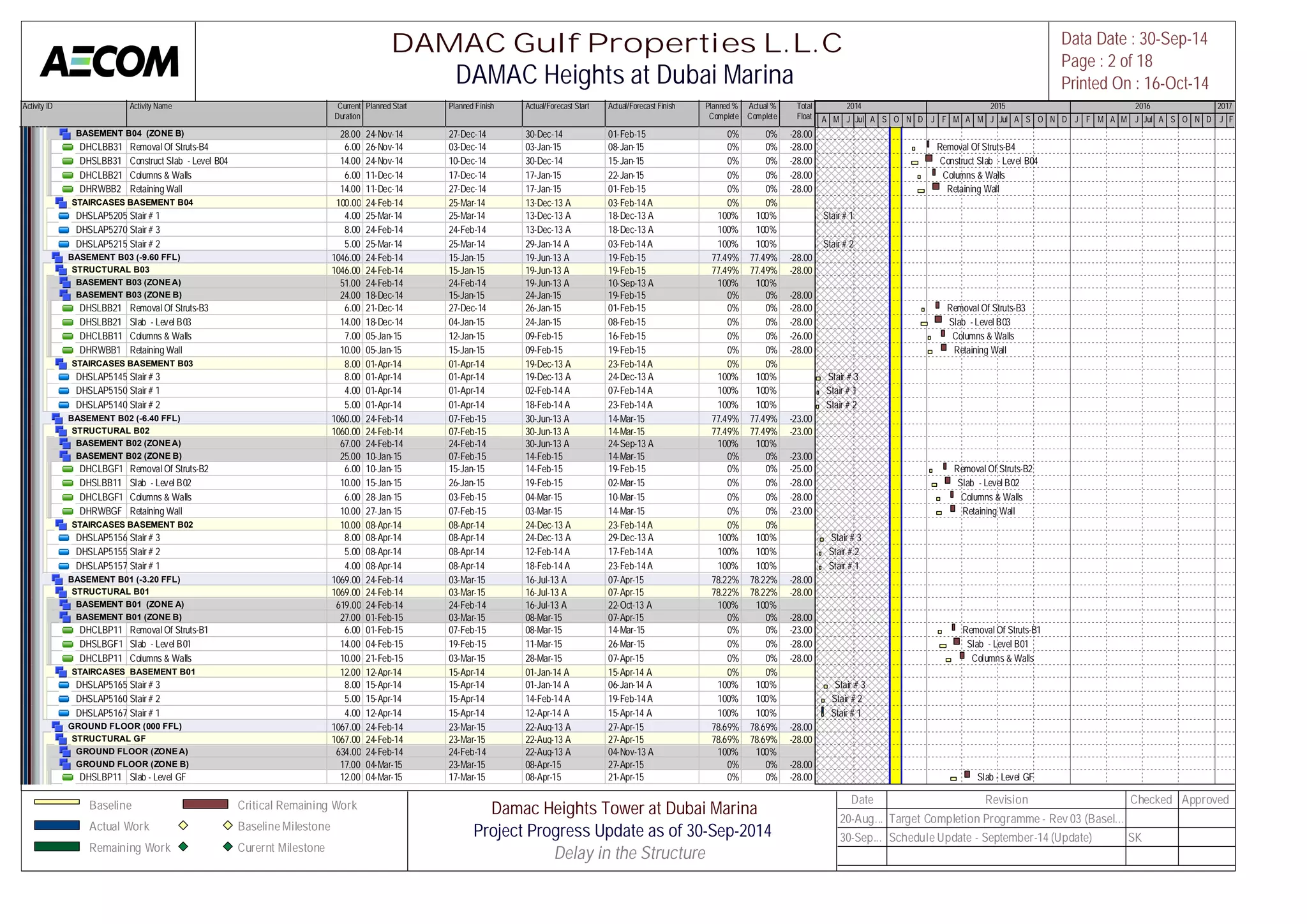

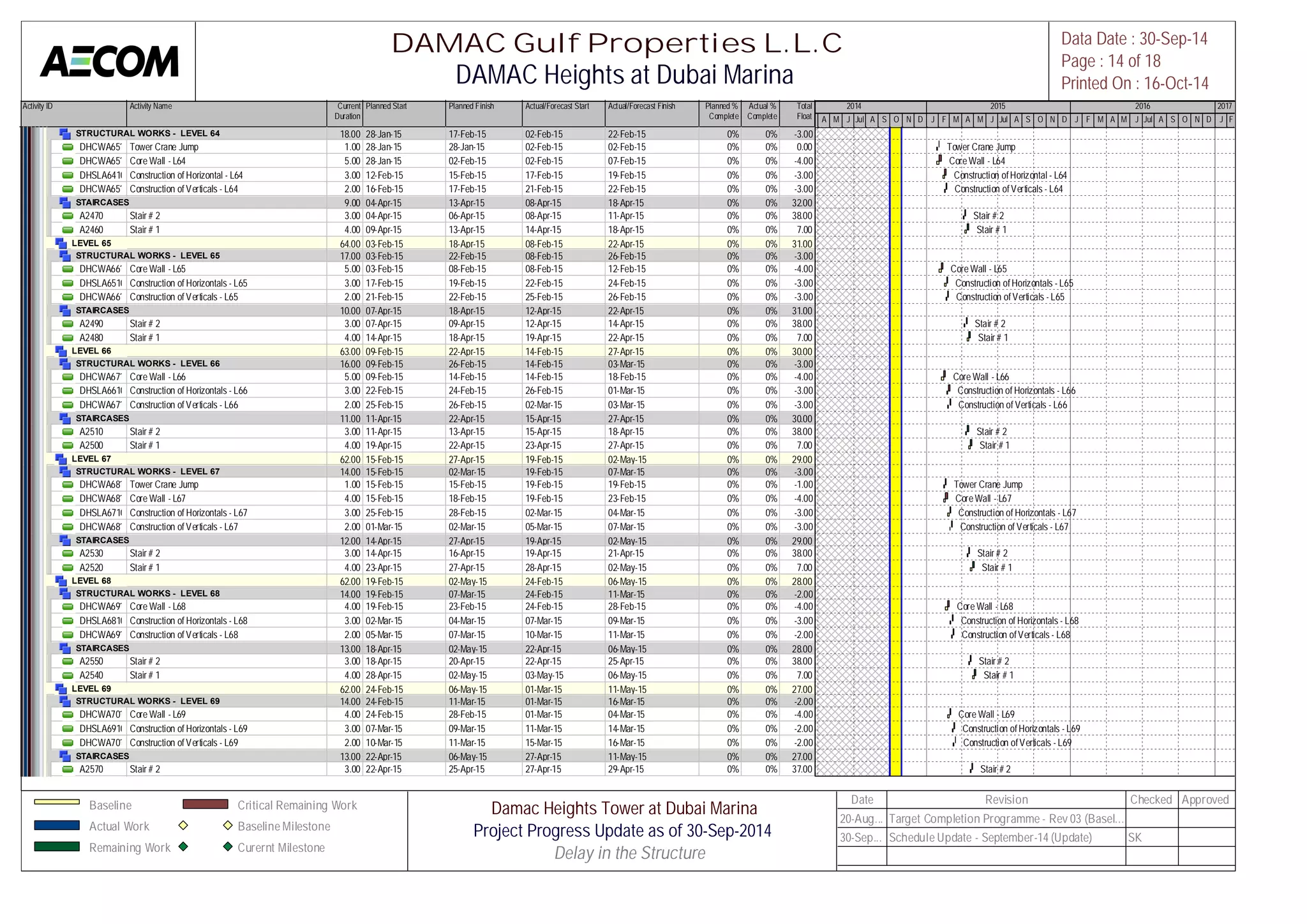

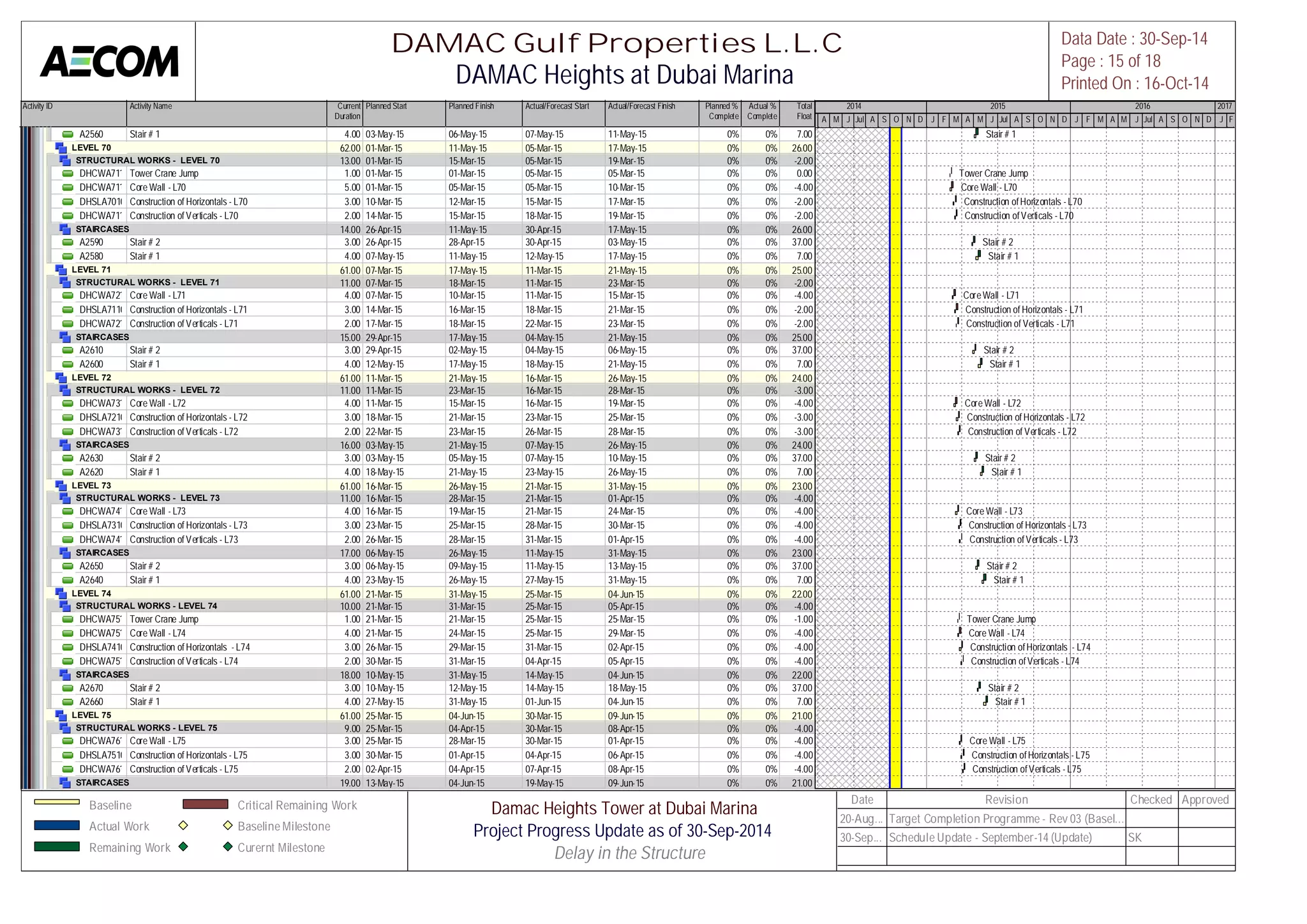

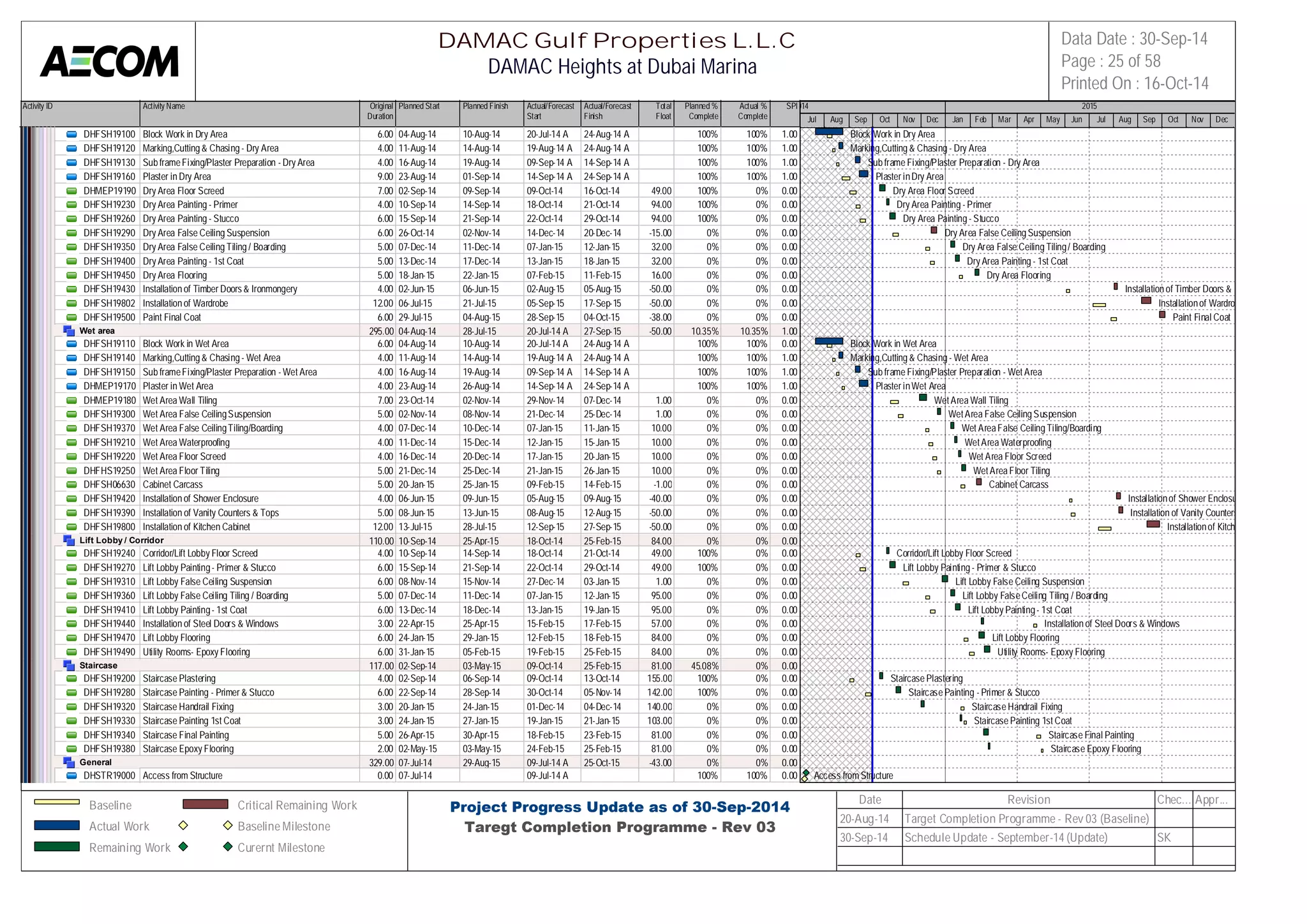

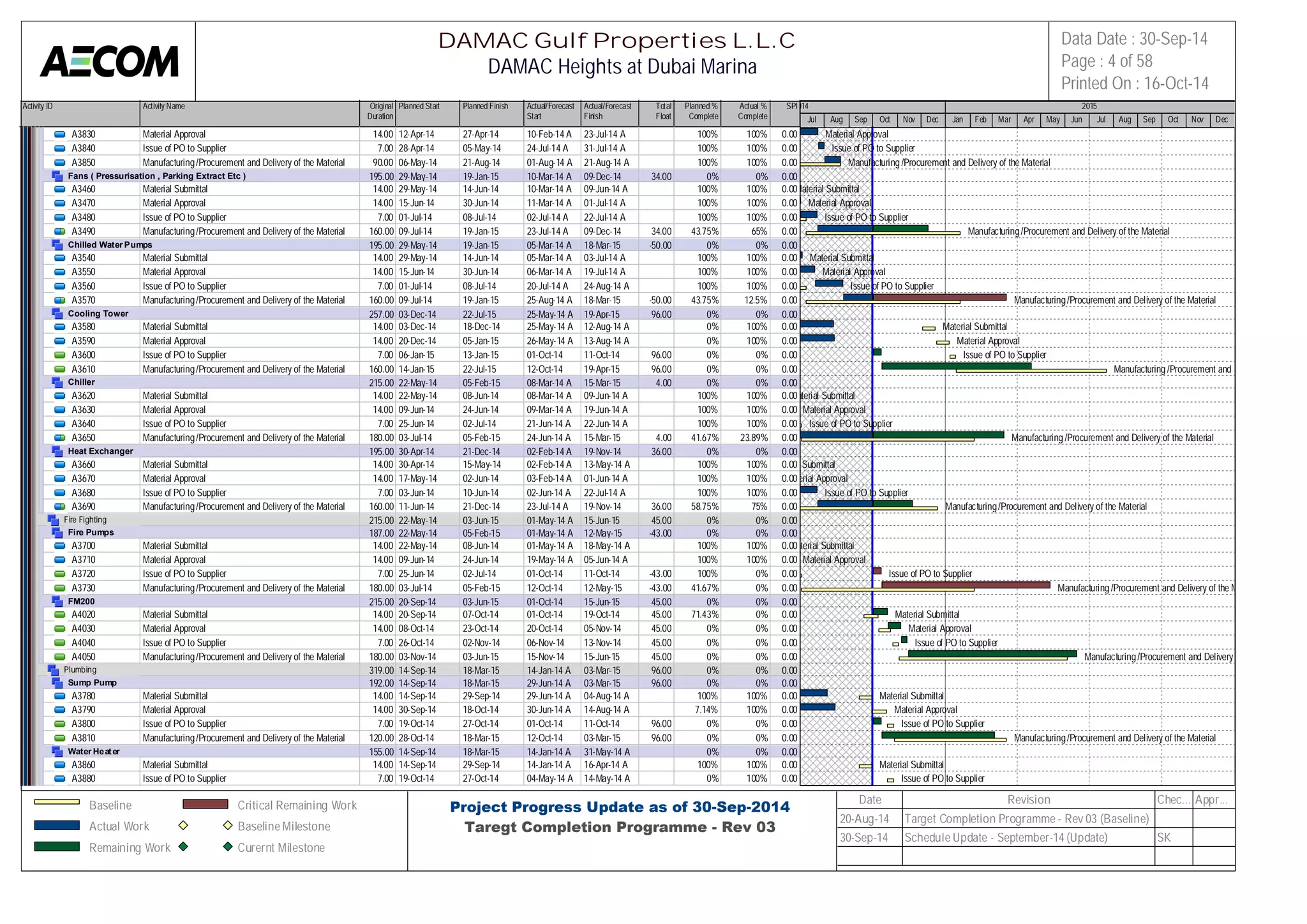

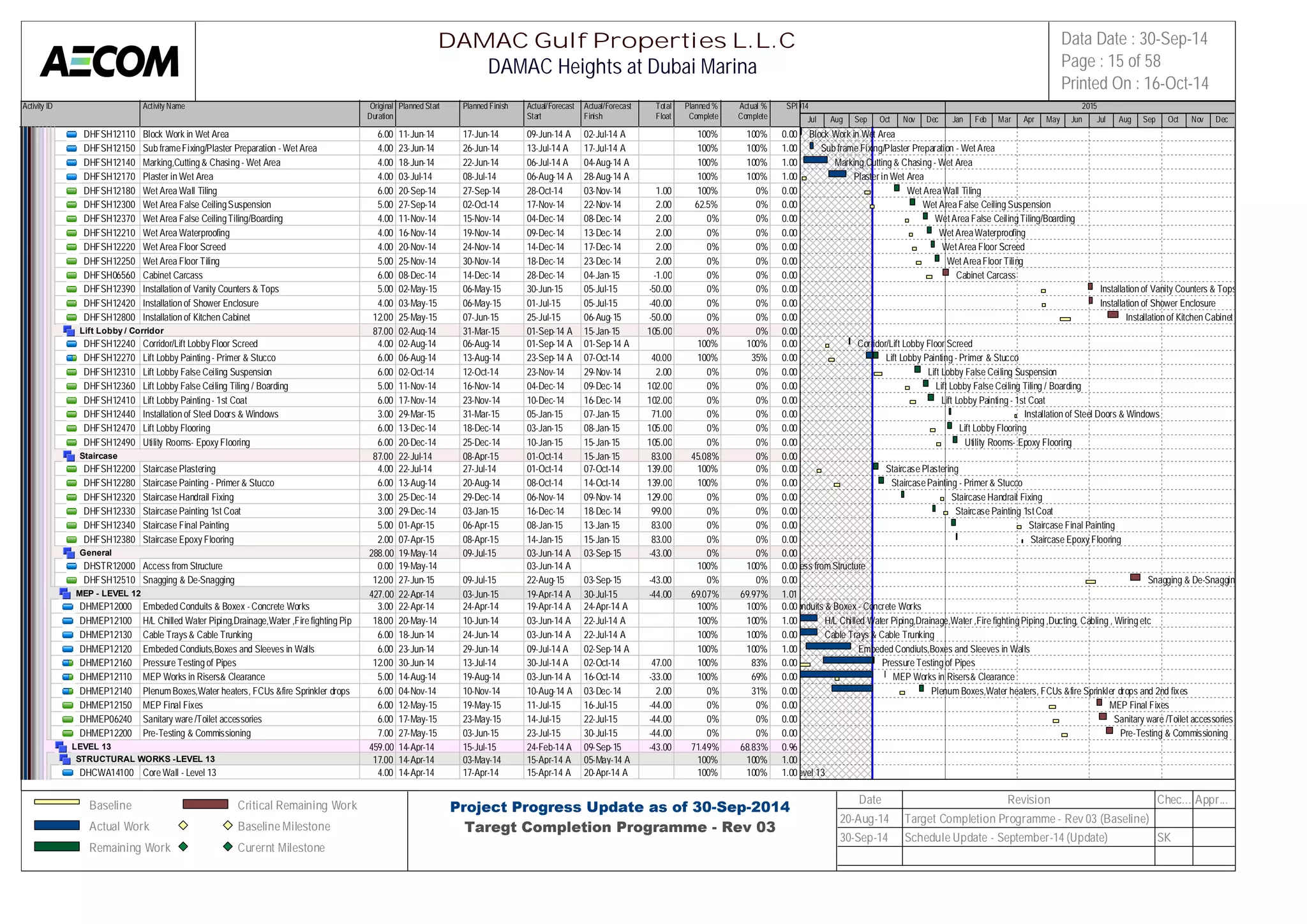

Upcoming Activities - 30 Days Look Ahead
C
14
Monthly Progress Report No. 7 - September 2014

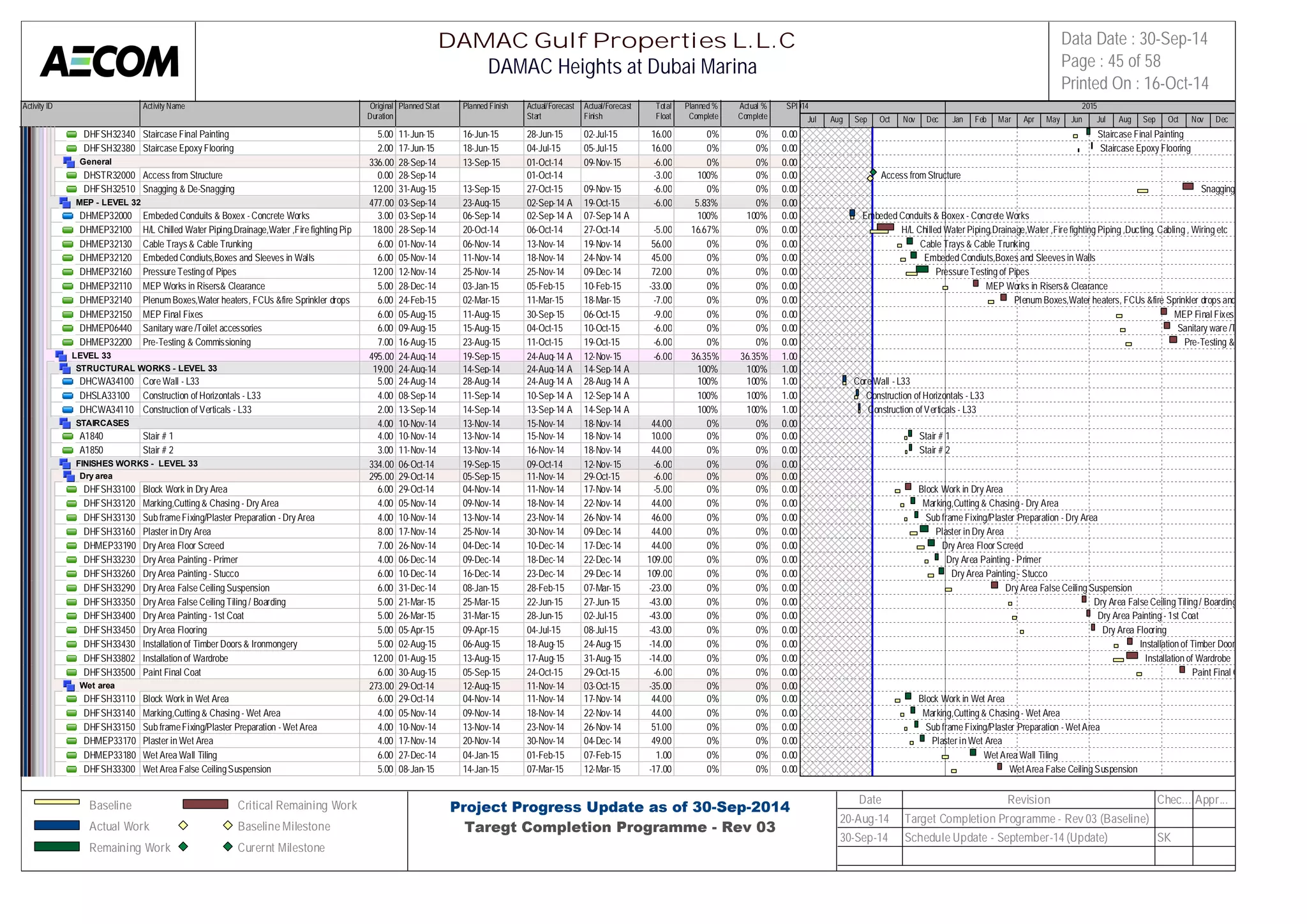

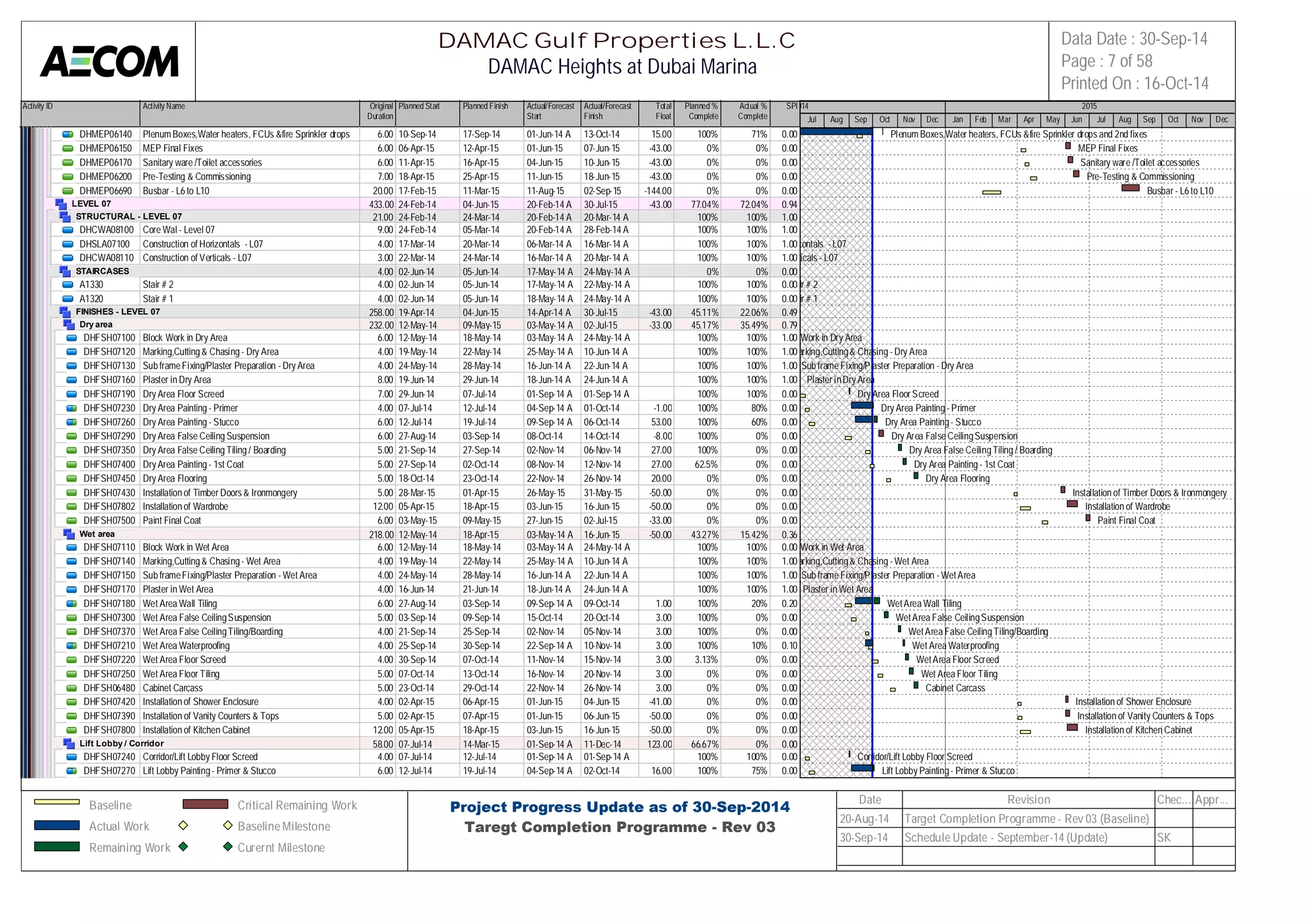

Activity Type Start Finish Activity
Slab L37 - Completion
Slab L38 - Completion
Slab L39 - Completion
Slab L40 - Completion
08.Okt.14
12.Okt.14
16.Okt.14
28.Okt.14 Slab L41 - Completion
Slab L42 - Completion
Core Wall L41 - Completion
Core Wall L42 - Completion
Core Wall L43 - Completion
Block Work Completion-L18
08.Okt.14
18.Okt.14
23.Okt.14
29.Okt.14
5-Oct-14
17-Oct-14
29-Oct-14
2-Oct-14
16-Oct-14
24-Oct-14
Block Work Completion-L27
Block Work Completion-L28
Block Work Completion-L29
Block Work Completion-L30
Block Work Completion-L31
Plaster Work Completion-L20

Plaster Work Completion-L22
Plaster Work Completion-L23
24-Oct-14 Plaster Work Completion-L24
Plaster Work Completion-L25
3-Oct-14
10-Oct-14
29-Oct-14
Plaster Work Completion-L21
21.Okt.14
03.Nov.14
Core Wall L39 - Completion
13.Okt.14 Core Wall L40 - Completion
Construction
31-Oct-14
2-Oct-14
2-Oct-14
2-Oct-14
3-Oct-14
Paint Work Completion-L6
Paint Work Completion-L7
Paint Work Completion-L8
Paint Work Completion-L9
6-Oct-14 Paint Work Completion-L10
9-Oct-14 Paint Work Completion-L11
13-Oct-14 Paint Work Completion-L12
17-Oct-14
27-Oct-14 Paint Work Completion-L15
Monthly Progress Report No. 7 - September 2014
9-Oct-14
Paint Work Completion-L13
21-Oct-14 Paint Work Completion-L14
C
C
C
C
C
C
C
C
C
C
Upcoming Activities - 30 Days Look Ahead
Activity Type Start Finish Activity
MEP H/L Completion - L29
C
C
C
C
ALICO, Toshiba and JC Maclean detailed work schedules will
be submitted to the Engineer.
Continue reviewing ATC's new shop drawings submittals.
30-Oct-14
31-Oct-14 Finalize the open/overdue shop drawings submittals.
PT drawings for levels (64-84) will be resubmitted
again by ATC for 3rd party review.
Ramboll to provide updated drawings considering the
25-Oct-14 missing electrical points for level 43 and above.
Fabrication drawings to be submitted by ATC for the
Engineer review.
AECOM to propose the sequencing of de-strutting for
Zone B.
DAMAC/AECOM will conclude a solution to the
diaphragm wall.
Finalize the open/overdue material submittals.
1-Oct-14 31-Oct-14
15-Oct-14
15-Oct-14
15-Oct-14
15-Oct-14
1-Oct-14 31-Oct-14
Procurement 21-Oct-14 Unitized curtain wall will be delivered to site.
Quality
1-Oct-14 LPO will be issued for Corridor Tiles.
1-Oct-14 31-Oct-14 ATC will keep closing the outstanding NCRs.
1-Oct-14 31-Oct-14
Quality Technical Meeting will be held on weekly basis to
monitor the quality.
1-Oct-14
20-Oct-14 LPO for secondary steel strucutre will be issued.
1-Oct-14
20-Oct-14 RME has to release the Steam and Sauna Package.
Construction
23.Okt.14
MEP H/L Completion - L31
MEP H/L Completion - L32
11.Okt.14
20.Okt.14
27.Okt.14
MEP H/L Completion - L30
Schedule
15-Oct-14
Electrical design NOC will be issued.
Engineering
31-Oct-14
15-Oct-14 DAMAC will finalize the nomination of Façade Light.
Re-nomination for the sanitary wares packages by
DAMAC.
15-Oct-14
Continue reviewing ATC's new material submittals.
C
C
C
C
C
C
C
15
Upcoming Activities - 30 Days Look Ahead
DAMAC will continue float tenders and receiving
quotations for the provisional sum items.
Critical Path Activity
1-Oct-14 31-Oct-14
10-Oct-14 Payment Certificate (IPC) for August 2014 will be issued.
Commercial
31-Oct-14 Finalize the list of pending variations submitted by ATC.
1-Oct-14
Monthly Progress Report No. 7 - September 2014
Activity Type Start Finish Activity
C
16
Monthly Progress Report No. 7 - September 2014
Dashboard
R
Report
17
Schedule Progress
Control Milestones
Clause 14
Program
Current
Forecast
Monthly Progress Report No. 7 - September 2014
-220
18-Jun-14 20-Dec-16 -182 - 3 0.00
14-May-15
-6
8-Aug-13 20-May-15 -4 3.00
-58
6-Mar-13 5-May-15 -50 5 0.00
26-Aug-13 6-Aug-15 -14 7 9.00
26-Nov-13 2-Jan-16 -46 1 0.00
-35
11-Dec-12 9-Jul-15 -28 - 4 7.00
5-Jan-13 29-Nov-14 -5 - 8.00
18-Sep-12 30-Oct-14 -57 4 .00
23-Mar-14 7-Mar-16 0 - 6.00
28-Mar-13 7-Oct-15 -28 - 3 6.00
Upward Trend Downward Trend
90%
34%
5%
Milestone
60- Days look Ahead Critical Activities
TCP - Rev 3
No Change
Current
Forecast
02.Okt.14 -6 - 6.00
08.Okt.14 -4 - 3.00
13.Okt.14 -3 - 3.00
18.Okt.14 -3 - 3.00
23-Oct-14 -5 - 5.00
29.Okt.14 -5 - 4.00
04.Nov.14 -5 - 6.00
09.Nov.14 -4 - 5.00
15.Nov.14 -4 - 6.00
22-Feb-16
31-Aug-15
2) Variance since Aug-14: the difference between Current forecast in Sep
vs. forecast in Aug.
Activity
Slab L37 - Completion
Slab L38 - Completion
Slab L39 - Completion
Slab L41 - Completion
Slab L42 - Completion
Slab L43 - Completion
Slab L44 - Completion
Slab L45 - Completion
Total
Variance
8-Mar-15
21-Jul-15
8-Nov-15
4-Jun-15
24-Nov-14
9-Sep-14
MS01 - Project Completion
MS02-Completion of Structure
MS03 - Producing Wild Air (till
30th Floor)
MS04 - Producing Wild Air (31-
62th Floor)
MS05 - Producing Wild Air
(above 62th Floor)
MS06 - Completion of P5 Slab at
Zone B
MS07 - Completion of Block
Work till Level 36th
MS08 - Completion of Façade
Works (level 6 till level 10)
TCP - Rev 3 Current Float
-5
-51
Variance
since Aug 14
Variance
since Aug 14
08.Okt.14
> 5 days
0 to 5 days
< 0 days
28.Okt.14
03.Nov.14
09.Nov.14
13.Nov.14
19.Nov.14
-55
-14
-37
12.Okt.14
-16
14-May-16
MS09 - Completion of Lift Works
MS10 - Commencement of
Swimming Pool Works
Note: 1) Total Variance: the difference between TCP and Current Forecast.
Slab L40 - Completion 21.Okt.14
Total
Variance
16.Okt.14
18
60- Days look Ahead Critical Activities
TCP - Rev 3
Monthly Progress Report No. 7 - September 2014
25.Nov.14
30.Nov.14
20-Nov-14 -5 - 6.00
25.Nov.14 -5 - 6.00
30.Nov.14 -6 - 6.00
01.Okt.14 -7 - 9.00
08.Okt.14 -5 - 6.00
13.Okt.14 -5 - 6.00
19.Okt.14 -4 - 8.00
23.Okt.14 -6 - 9.00
29.Okt.14 -5 - 7.00
03.Nov.14 -5 - 6.00
09.Nov.14 -4 - 8.00
15.Nov.14 -4 - 9.00
19.Nov.14 -5 - 8.00
24.Nov.14 -5 - 7.00
29.Nov.14 -5 - 8.00
Activity
Slab L46 - Completion
Slab L47 - Completion
Slab L48 - Completion

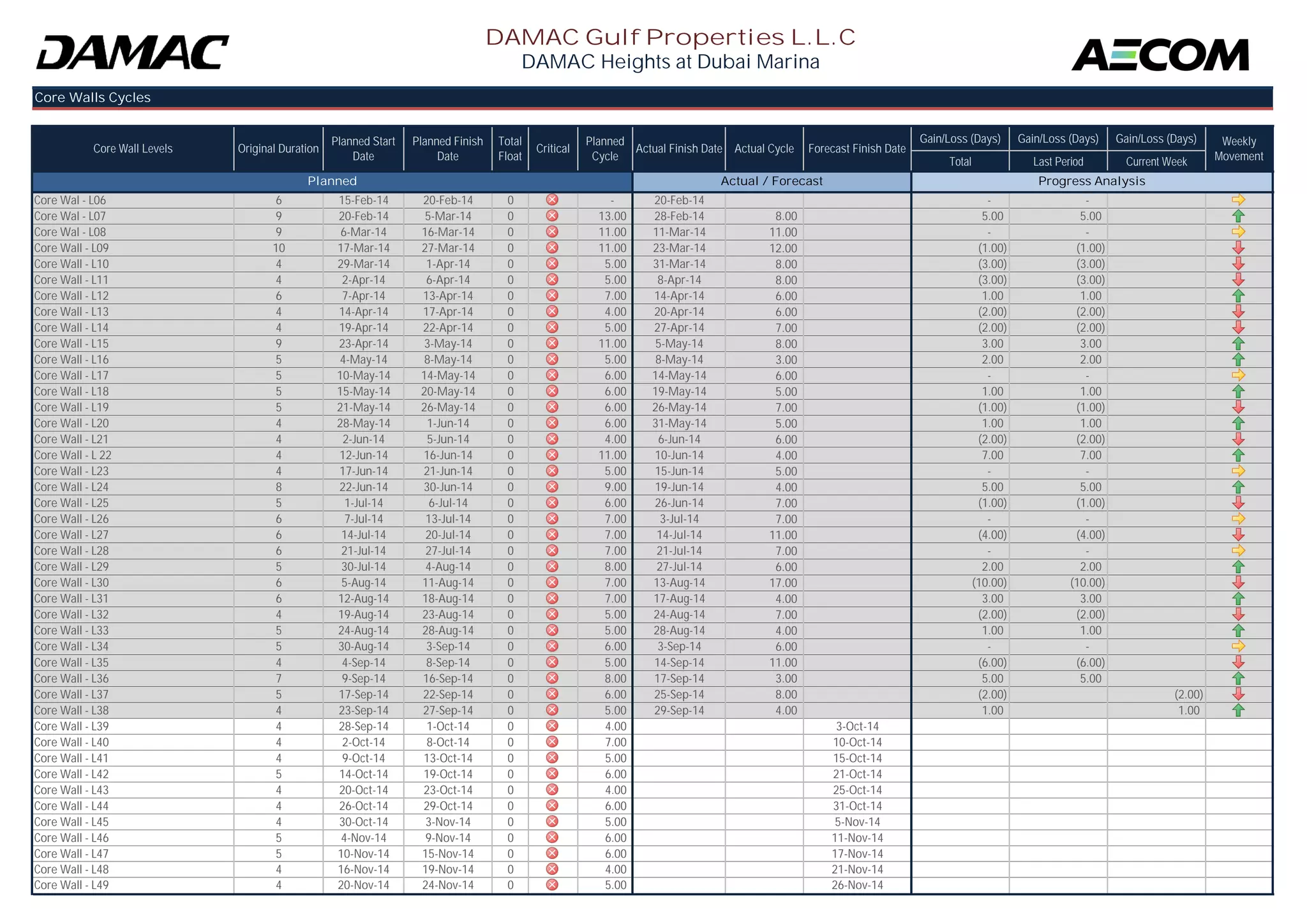

Core Wall L39 - Completion
Core Wall L40 - Completion
Core Wall L41 - Completion
Core Wall L42 - Completion
Core Wall L43 - Completion
Core Wall L46 - Completion
Core Wall L47 - Completion
Core Wall L48 - Completion
Core Wall L49 - Completion
06.Dez.14
08.Okt.14
13.Okt.14
18.Okt.14
23.Okt.14
13.Nov.14
19.Nov.14
Core Wall L50 - Completion 04.Dez.14
3-Oct-14
Block Work Completion-L18 05.Aug.14 -59 - 3 0.00
Block Work Completion-L27 28.Sep.14 5-Oct-14
-7 - 7.00
Block Work Completion-L28 07.Okt.14 10-Oct-14
-3 - 6.00
Block Work Completion-L29 14.Okt.14 17-Oct-14
-3 - 7.00
Block Work Completion-L30 26.Okt.14 29-Oct-14
-3 - 1 3.00
Block Work Completion-L31 26.Okt.14 29-Oct-14
-3 - 7.00
Block Work Completion-L32 30.Okt.14 2-Nov-14
-3 - 5.00
Block Work Completion-L33 04.Nov.14 9-Nov-14
-5 - 6.00
Block Work Completion-L34 11.Nov.14 16-Nov-14
-5 - 7.00
Block Work Completion-L35 18.Nov.14 23-Nov-14
-5 - 8.00
Block Work Completion-L36 24.Nov.14 29-Nov-14
-5 - 8.00
Plaster Work Completion-L20 06.Sep.14 2-Oct-14
-26 - 6.00
Plaster Work Completion-L21 11.Sep.14 9-Oct-14
-28 - 7.00
Plaster Work Completion-L22 17.Sep.14 16-Oct-14
-29 - 8.00
Plaster Work Completion-L23 22.Sep.14 24-Oct-14
-32 - 1 0.00
Plaster Work Completion-L24 28.Sep.14 -26 - 4.00
Plaster Work Completion-L25 06.Okt.14 -25 - 5.00
Plaster Work Completion-L26 13.Okt.14 -19 - 2.00
Plaster Work Completion-L27 21.Okt.14 -16 - 1.00
Plaster Work Completion-L28 29.Okt.14 11-Nov-14
-13 - 1.00
Plaster Work Completion-L29 05.Nov.14 16-Nov-14
-11 - 4.00
Plaster Work Completion-L30 16.Nov.14 22-Nov-14
-6 - 2.00
Total
Variance
Current
Forecast
29.Okt.14
Core Wall L44 - Completion 03.Nov.14
Core Wall L45 - Completion 08.Nov.14
Variance
since Aug 14
24.Nov.14
29.Nov.14
24-Oct-14
31-Oct-14
1-Nov-14
6-Nov-14
19
60- Days look Ahead Critical Activities
TCP - Rev 3
Monthly Progress Report No. 7 - September 2014
Current
Forecast
30-Nov-14
Plaster Work Completion-L31 16.Nov.14 -14 - 5.00
Paint Work Completion-L6 12.Jul.14 -82 - 2 6.00
Paint Work Completion-L7 19.Jul.14 2-Oct-14
-75 - 2 0.00
Paint Work Completion-L8 23.Jul.14 2-Oct-14
-71 - 1 5.00
Paint Work Completion-L9 30.Jul.14 3-Oct-14
-65 - 1 6.00
Paint Work Completion-L10 04.Aug.14 6-Oct-14
-63 - 1 7.00
Paint Work Completion-L11 09.Aug.14 -61 - 1 7.00
Paint Work Completion-L12 13.Aug.14 -61 - 1 7.00
Paint Work Completion-L13 18.Aug.14 -60 - 1 7.00
Paint Work Completion-L14 23.Aug.14 -59 - 1 9.00
Paint Work Completion-L15 27.Aug.14 -61 - 1 9.00
Paint Work Completion-L16 01.Sep.14 -62 - 1 9.00
Paint Work Completion-L17 08.Sep.14 -61 - 1 9.00
Paint Work Completion-L18 15.Sep.14 -60 - 1 9.00
Paint Work Completion-L19 21.Sep.14 21-Nov-14
-61 - 2 0.00
Paint Work Completion-L20 25.Sep.14 27-Nov-14
-63 - 2 0.00
Paint Work Completion-L21 01.Okt.14 6-Dec-14
-66 - 2 3.00
MEP H/L Completion - L29 07.Okt.14 11.Okt.14
-4 8.00
MEP H/L Completion - L30 11.Okt.14 23.Okt.14
-12 1.00
MEP H/L Completion - L31 14.Okt.14 20.Okt.14
-6 7.00
MEP H/L Completion - L32 20.Okt.14 27.Okt.14
-7 6.00
MEP H/L Completion - L33 28.Okt.14 03.Nov.14
-6 6.00
MEP H/L Completion - L34 04.Nov.14 10.Nov.14
-6 6.00
MEP H/L Completion - L35 11.Nov.14 17.Nov.14
-6 6.00
MEP H/L Completion - L36 17.Nov.14 23.Nov.14
-6 6.00
MEP H/L Completion - L37 23.Nov.14 29.Nov.14
-6 7.00
90%
34%
5%
Variance
since Aug 14
Activity
2-Oct-14
9-Oct-14
13-Oct-14
17-Oct-14
21-Oct-14
27-Oct-14
2-Nov-14
8-Nov-14
14-Nov-14
Total
Variance
Upward Trend Downward Trend No Change
> 5 days
0 to 5 days
< 0 days
20
Physical % Complete
30
25
20
15
10
5
* Note: Physical % Complete based on TCP - Rev 3.
Nomination of PS Items
Clause 14
Program
TCP - Rev 3 Current Float
Var. since
Aug 14
7-May-15
10-Aug-13 7-May-15 51 -
1-Oct-14
2-Feb-12 24-Feb-14 -178 - 30.00
1-Oct-14
3-Jun-12 20-Aug-14 69 - 30.00
21-Nov-12 20-Nov-14
15-Jan-13 18-Apr-13 Nominated
4-Mar-13 4-Nov-14 116 -
13-Nov-14 20 -
17-Apr-13 3-Sep-14 171 -
90%
34%
5%
SC Nomination for
Fit Out (Life Style)
SC Nomination for
Fit Out (Fendi Flat)
SC Nomination for
Sauna,Jacuzzi
Critical Path (TCP-Rev 3)
Work Packages 2013 2014 2015 2016
Planned Actual
Impact on MS02
0.89
Schedule Performance
Index (SPI)
SC Nomination for
Fit Out (Entrance)
SC Nomination for
Façade Lighting
SC Nomination for
Swimming Pool
No Change
Milestone
Nominated
Downward Trend
> 5 days
0 to 5 days
Monthly Progress Report No. 7 - September 2014
Progress % Complete
Days Remaining until
MS02
4-Nov-14
Impact on MS01
Concrete Skeleton
Fit Out after Wild Air
Façade Glazing
Lifts
Testing/Commissioning
Current
Forecast
< 0 days
13-Nov-14
1-Oct-14
Upward Trend
SC Nomination for
Landscaping Works
SC Nomination for
Roof Steel Works
Snagging
9.09
9.62 10.57
11.53 12.48
15.29
18.4
22.35 25.15
7.4
9.62 10.21 10.81 11.4
13.62
16.04
18.95
22.46
0
Planned % Actual %
- 182
- 4
22.5
226
21
Negative Float Contour
Dominant Causes for Project Delays
-10
Monthly Progress Report No. 7 - September 2014
Critical Paths Analysis
Paths Package Activities
Path 3 (Curtain Wall) Path 1 Façade Light
Nomination, Procurement,
Engineering, Installation.
Path 4 (MEP Long Lead Items (Mechanical))
-20
Path 1 (Façade Light)
Path 2 ( Bus Bars and LV Panels)
-40
-144
-182
* Note: The shown analysis was run based on TCP-Rev 03, however, this version isn't approved so the shown analysis is only a tentative
one.
Path 3 Curtain Wall
Installation of 7 elements for
external façade (unitized system,
stick system, doors, balcony
partitions, cladding, balustrade and
louvers.
Float
- 182.00
- 51.00
Path 4
MEP Long Lead
Items (Mechanical)
CW pumps submission/approval,
procurement/installation, producing
wild air, fit out works by JC
Maclean.
- 50.00
Path 2
-144 days
Path 1
-182 days
Path 3
-51 days
Path 4
-50 days
-182 THIS MONTH
DELAYS IDENTIFIED
Path 2
Bus Bars and LV
Panels
Procurement/installation of Bus
Bars and LV Panels.
- 144.00
Analysis run on 30-September-14
22
Risk Analysis
Risk Analysis on Critical Paths
Monthly Progress Report No. 7 - September 2014
• Risk: Delay of -182 days
• Driver: Late of Nomination of Façade Light
• Mitigation:
• The Engineer is of the view that the facade light
nomination will not affect the project completion
date, as the light fixtures will be installed before
the project completion, which means there is
enough time for procurement and engineering.
• However, it is recommended that the client to
expedite the nomination to avoid any risk to
coordinate procurement with other parties.
• Risk: Delay of -144 days
• Driver: Procurement of Bus Bars and LV
Panels
• Mitigation:
• An instruction issued by DAMAC to ATC to
proceed with procuring the Bus Bars and LV
Panels. The LPO will be issued during the month
of October 2014.
• On the other hand DAMAC/AECOM are working
to get the NOC from Emaar in order to seek the
design NOC from DEWA.
Analysis run on 30-September-14
• Risk: Delay of -51 days
• Driver: Delay in Curtain Wall Installation
• Mitigation:
• The design of secondry steel structure was done
by ALICO.
• ATC to submit the fabrication drawings to the
engineer for approval.
• Unitized panels will be delivered to site by 21-
Oct-14.
• Risk: Delay of -50 days
• Driver: Chilled Water Pumps
• Mitigation:
• On the basis that the chilled water pumps will
contribute in producing wild air so that the delay
in submission the material submittal affected the
delivery date to site and thus affected the
commencement of wild air operation. However,
the pumps are approved and the purchase order
will be issued during August 2014.
• The Engineer is of the view that the wild air is a
vague issue so that Arabtec has been instructed
many time in the weekly progress meetings to
plan the wild air operation to allow the fit out
work start and submit a proposal for review,
however, ATC stated that the term ''wild air'' is
not in the contract.
Path 1
Path 2
Path 3
Path 4
Path 1 Path2 Path3 Path 4
200
180
160
140
120
100
80
60
40
20
0
Paths 182 144 51 50
Delays
Critical Paths
23
Slabs Planned Pouring Actual Pouring Progress Variance
23rd floor 02.Jul.14 4-Jul-14 100% - 2 .00
24th floor 10.Jul.14 10-Jul-14 100% - 1 .00
25th floor 19.Jul.14 17-Jul-14 100% 1 .00
26th floor 26.Jul.14 23-Jul-14 100% - 1 .00
27th floor 03.Aug.14 1-Aug-14 100% 1 .00
28th floor 09.Aug.14 9-Aug-14 100% -
29th floor 16.Aug.14 14-Aug-14 100% -
30th floor 23.Aug.14 22-Aug-14 100% - 1 .00
31st floor 31.Aug.14 31-Aug-14 100% -
32nd floor 06.Sep.14 7-Sep-14 100% - 1 .00
33rd floor 11.Sep.14 12-Sep-14 100% -
34th floor 16.Sep.14 18-Sep-14 100% - 1 .00
35th floor 21.Sep.14 24-Sep-14 100% - 1 .00
36th floor 27.Sep.14 30-Sep-14 100% - 3 .00
Progress Photographs
Structure Progress - Level 36
Zone B - Section DD; Seepage Area
Monthly Progress Report No. 7 - September 2014
57.12%
5.69%
17.50%
9.42%
12.38%
%Pld %Act
0.00%
0.00%
3.42%
56.34%
3.38%
16.04%
20.63%
2.10%
0.38%
DAMAC Heights
Tower
24
Core Walls Planned Pouring Actual Pouring Progress Variance
23rd floor 21.Jun.14 15-Jun-14 100% -
24th floor 30.Jun.14 19-Jun-14 100% 2 .00
25th floor 06.Jul.14 26-Jun-14 100% 2 .00
26th floor 13.Jul.14 3-Jul-14 100% - 1 .00
27th floor 20.Jul.14 14-Jul-14 100% - 1 .00
28th floor 27.Jul.14 21-Jul-14 100% - 1 .00
29th floor 04.Aug.14 27-Jul-14 100% 1 .00
30th floor 11.Aug.14 13-Aug-14 100% 2 .00
31st floor 18.Aug.14 17-Aug-14 100% 7 .00
32nd floor 23.Aug.14 24-Aug-14 100% - 1 .00
33rd floor 28.Aug.14 28-Aug-14 100% 6 .00
34th floor 03.Sep.14 3-Sep-14 100% - 3 .00
35th floor 08.Sep.14 14-Sep-14 100% - 2 .00
36th floor 16.Sep.14 17-Sep-14 100% - 6 .00
37th floor 22.Sep.14 25-Sep-14 100% - 3 .00
38th floor 27.Sep.14 29-Sep-14 100% - 1 .00
Progress Photographs
Dry Area: False Ceiling Suspension System @ Level 6
Corridor: False Ceiling Boards @ Level 6
Monthly Progress Report No. 7 - September 2014
57.12%
5.69%
17.50%
9.42%
12.38%
%Pld %Act
0.00%
0.00%
3.42%
56.34%
3.38%
16.04%
20.63%
2.10%
0.38%
DAMAC Heights
Tower
25
HVAC HL Works Planned Finish Actual Finish Progress Variance
24th floor 30.Aug.14 91%
25th floor 06.Sep.14 90%
26th floor 13.Sep.14 90%
27th floor 21.Sep.14 84%
28th floor 28.Sep.14 69%
29th floor 07.Okt.14 52%
FF HL Works Planned Finish Actual Finish Progress Variance
24th floor 30.Aug.14 99%
25th floor 06.Sep.14 98%
26th floor 13.Sep.14 96%
27th floor 21.Sep.14 96%
28th floor 28.Sep.14 88%
29th floor 07.Okt.14 78%
Progress Photographs
Wet Area: Wall Tiles and Water Proofing @ Level 6
Painting (Primer & Putty) @ Level 13
Monthly Progress Report No. 7 - September 2014
57.12%
5.69%
17.50%
9.42%
12.38%
%Pld %Act
0.00%
0.00%
3.42%
56.34%
3.38%
16.04%
20.63%
2.10%
0.38%
DAMAC Heights
Tower
26
Progress Photographs Monthly Progress Report No. 7 - September 2014
Plumbing HL Work Planned Finish Actual Finish Progress Variance
24th floor 30.Aug.14 95%
25th floor 06.Sep.14 95%
26th floor 13.Sep.14 95%
27th floor 21.Sep.14 95%
28th floor 28.Sep.14 95%
29th floor 07.Okt.14 49%
Electrical HL Work Planned Finish Actual Finish Progress Variance
24th floor 30.Aug.14 94%
25th floor 06.Sep.14 80%
26th floor 13.Sep.14 94%
27th floor 21.Sep.14 90%
28th floor 28.Sep.14 90%
29th floor 07.Okt.14 84%
MEP High Level Service @ Level 27
Foundation for Equipment @ Level 30
57.12%
5.69%
17.50%
9.42%
12.38%
%Pld %Act
0.00%
0.00%
3.42%
56.34%
3.38%
16.04%
20.63%
2.10%
0.38%
DAMAC Heights
Tower
27
Monthly Progress Report No. 7 - September 2014 Progress Photographs
Blocks Planned Finish Actual Finish Progress Variance
17th floor 27-Jul-14 95%
18th floor 5-Aug-14 50%
19th floor 10-Aug-14 95%
20th floor 16-Aug-14 95%
21st floor 20-Aug-14 95%
22nd floor 27-Aug-14 95%
23rd floor 1-Sep-14 95%
24th floor 7-Sep-14 95%
25th floor 13-Sep-14 95%
26th floor 20-Sep-14 95%
27th floor 28-Sep-14 70%
28th floor 7-Oct-14 15%
29th floor 14-Oct-14 5%
Substation - Trenches and Block Wall
Stick Curtain Wall - Aluminium Cladding
57.12%
5.69%
17.50%
9.42%
12.38%
%Pld %Act
0.00%
0.00%
3.42%
56.34%
3.38%
16.04%
20.63%
2.10%
0.38%
DAMAC Heights
Tower
28
Concealed MEP Planned Finish Actual Finish Progress Variance
19th floor 21-Aug-14 98%
20th floor 27-Aug-14 99%
21st floor 02.Sep.14 96%
22nd floor 08.Sep.14 96%
23rd floor 13.Sep.14 90%
24th floor 18.Sep.14 59%
Plaster Planned Finish Actual Finish Progress Variance
17th floor 19-Aug-14 95%
18th floor 26-Aug-14 2%
19th floor 1-Sep-14 95%
20th floor 6-Sep-14 70%
21st floor 11-Sep-14 13%
22nd floor 17-Sep-14 5%
Progress Photographs
Stick Curtain Wall - Galss Panels
Brackets Installation for Balcony Balustrade
Monthly Progress Report No. 7 - September 2014
57.12%
5.69%
17.50%
9.42%
12.38%
%Pld %Act
0.00%
0.00%
3.42%
56.34%
3.38%
16.04%
20.63%
2.10%
0.38%
DAMAC Heights
Tower
29
Health, Safety & Environment
HSE Statistics
Total Hours
Worked
Work Force
(Average)
Monthly Progress Report No. 7 - September 2014
Fatalities Lost Time Injury
First
Aid
Cases
Near
Misses
381,010 1465 0 0 2 3
4,292,339 1402 0 4 182 15
4,673,349 0 0 4 184 18
* Note:
HSE Site Inspections
Site Observations
Notices (Improvement &
Stop Works)
Issues Closed Open Issued Closed Open
Safety
Audits
(Average)
5 - 14 10 4 2 1 2
128 - 174 172 2 22 21 1
133 - 188 182 6 24 22 2
HSE Training & Seminars
Orientation
for New Hires
308
4,440
4,748
Significant Incidents
1
2
3
4
5
6
Critical Manageable
Severe Negligible
This Month
19
No. of Training Tool Box Talks Safety Training
Safety Meetings
Description/Comments Risk Rate
Joint
Inspections
Recordable
Injuries
0
19
Previous Months
Total Project
This Month
Previous Months
Total Project
4
66
70
Current Month
Previous Months
Total Project
195
1346
1541
5
60
65
Water seepage in section DD and a subsequent soil settlement along section BB and DD.
C
S
M
N
C
30
May Statistics
0
(0)
0
(4)
0
(19)
2
(184)
14
(188)
LTI & Lost Work Days
Monthly Progress Report No. 7 - September 2014
Fatalities
LTI
Total Hours Worked this
Month
Total Hours Worked Previous
Months
Total Hours Worked For the
Project
Work Force Average
Notices Issued this Month
Current Month
(Cumulative Contract)
Recordable Injuries
First Aid Cases
Site Observations
Eye Injuries
0 (22)
Back Injuries
0 (4)
Face Injuries
0 (9)
Trunk Front Injuries
0 (4)
Hand Injuries
1 (62)
Head Injuries
0 (4)
Arm Injuries
1 (28)
Leg Injuries
1 (35)
Ankle/Foot Injuries
0 (14)
3.5
3
2.5
2
1.5
1
0.5
0
Lost Time Injury (LTI)
Lost Work Days (LWD)
381,010
4,292,339
4,673,349
1465
2
31
Engineering
NOCs Status Summary
Actual
Issue Date
17.Sep.13
GSM NOC RME/AECOM
19.Jun.14 -
23.Jän.11
14.Nov.13
25.Nov.13
10.Jul.14
09.Jun.13
27.Mai.14
06.Jul.14
05.Mai.13
25-Mar-13
27-Dec-11
25-Jun-12
9-Sep-13
90%
# 34% 30 to < 60 days
5%
RME
> 60 days
< 30 days
Note: Days remaining from 30 Sep 2014 to Anticipated Date
Expiry Date
Days
Remaining
Responsible
Dubai Civil Aviation
26.Mai.15 RME/AECOM
RME/AECOM
DEWA - Electrical
Electrical Load
Design NOC
04.Mai.15 RME/AECOM
LV Design Drawing
Approval
Revised
Approval is
required
RME/AECOM
Substation / Trench
Design Approval
Revised
Approval is
required
RME/AECOM
Authority
Etisalat Design NOC
& Drawings Approval
Monthly Progress Report No. 7 - September 2014
NOC/Permit
Anticipated
Issue Date
Height NOC
Warning Light NOC
Revised
Approval is
required
Final NOC after
final design
approval.
Water Supply Design
Drawing Approval
Revised
Approval is
required
RME/AECOM
Revised
Approval is
required
Revised
Approval is
required
16.Sep.15 RME/AECOM
Etisalat
RME
ATC
RME/AECOM
RME/AECOM
Revised
Approval is
required
Dubai Municipality
Fence NOC 22.Jul.11
Ground water
Discharge
08.Mai.14
Drainage Design NOC
and Drawings
Approval
FIC Location Approval
Dubai Civil Defense
Design Drawing
Approval
RME/AECOM
DEWA - Water
Water Design NOC 24-Mar-15 RME/AECOM
EMAAR
Water Seepage
Remedial Works
RME
Dewatering
Conditional NOC
24-Dec-12 RME
Drainage NOC 9-Dec-13
32
Critical Authorities Issues
Authority Action
Subject
NOCs &
Dwgs.
NOC
DEWA, DM and Civil Defence
Revised approvals are required due
to the architectural changes.
Engineering Submittal Status Report
Planned Date Current Forecast
1 2 3 4 5 6
17 3 12 - 1 0 1
1266 58 1055 6 73 66 8
72 37 28 1 5 1 0
209 39 128 0 17 22 3
3- Revise& Resubmit 5- Under Review
4- Rejected 6- Review not required
* Note: Only 2014 submittals have been considered.
Submitted Open Closed
367 35 332
209 39 170
72 7 65
90%
81%
90%
19 89%
1266 145 1121
17 1 16
1931 227 1704
Monthly Progress Report No. 7 - September 2014
EMAAR 30.Okt.14
1- Approved
2- Approved as Noted
Request for
Information
Materials
Method Statement
Prequalification
Approval
* Note: Only 2014 submittals have been considered.
94%
0
5
0
Review Category
Submittals Closed
% RFIs Closed
Document Submittal
Prequalification
Approval
NOC has to be given by Emaar in
order to seek the design NOC from
DEWA.
Submitted
0
Total 88%
Number of Submittals
Submittals Open
Shop Drawings
Method Statements
Materials
Document Submittal Overdue % Closed
Shop Drawings
88%
12%
Submittals Closed
Submittals Open
1931
1704
227
90%
33
Quality Assurance & Control
Non-Conformance Reports (NCR)
Category 1: Per Work Package
Monthly Progress Report No. 7 - September 2014
September NCRs Total NCRs
Issued Closed Open Issued
Close
d
Open Issued Closed Open
8 7 1 0 0 0 8 7 1
68 57 11 3 6 2 71 63 8
3 2 1 1 1 1 4 3 1
11 11 0 4 1 3 15 12 3
0 0 0 0 0 0 0 0 0
0 0 0 0 0 0 0 0 0
90 77 13 8 8 6 98 85 13
General
Architectural
MEP
Lifts
Category 2: Per Root Causes
September NCRs Total NCRs
Issued Closed Open Issued
Close
d
Open Issued Closed Open
5,16,44,45,56,62,
64,73,86.
9 8 1 0 1 0 9 9 0
6,8,11,12,14,15,21,22,2
3,24,26,27,29,
32,38,39,43,51,53,54,8
0,81,98.
22 22 0 1 1 0 23 23 0
9,28,99,102,104. 2 1 1 3 0 3 5 1 4
34,49,50,66. 4 4 0 0 0 0 4 4 0
1,37,40,69,82. 5 5 0 0 0 0 5 5 0
10,13,17,18,19,20,25,3
0,31,33,35,41,46,47,48,
52,55,57,58,59,60,65,6
8,70,71,72,74,75,76,77,
78,79,83,84,85,88,89,9
0,91,94,96,100,101.
40 30 10 3 5 3 43 35 8
2,3,7,42,61,63,67,87,95
.
8 7 1 1 1 0 9 8 1
90 77 13 8 8 6 98 85 13
Use of Unapproved Drawings/Materials
Deviation from Specifications
Not Following Manufacturer's Instructions
Deviation from the Safety Requirements
Not working as per Method Statement
Bad Workmanship
Others
Total
Use of Unapproved
Drawings/Material
Total
Work Area
Previous NCRs
Others
NCR ID
Deviation from Specifications
Not Following Manufacturer's
Instructions
Deviation from the Safety
Requirements
Not working as per Method
Statement
Bad Workmanship
Previous NCRs
Work Area
Structural
External Façade
9
23
5
4
5
43
9
A
B
C
D
E
F
G
34
Key Quality Improvement Measures
Implemented in the Month
• CurreŶtlLJ ATC keeps suďŵittiŶg the ĐoŶĐrete test results iŶ tiŵelLJ ŵaŶŶer
as was instructed by AECOM.
• AECOM iŶstruĐted ATC to suďŵit the struĐtural ĐlearaŶĐe ďefore the
commencement of MEP work.
• AECOM is going to hold Quality Technical Meetings on weekly basis to
monitor the quality.
Audits
Internal External
Quality Trending
Monthly Progress Report No. 7 - September 2014
NCR Closed %
NCR Opened %
Total NCRs Raised
NCRs Closed
NCRs Opened
8 NON-CONFORMANCE
IDENTIFIED THIS
MONTH
Quality Improvement Measures
3
9
4
6
3 3
13
9
6
5
13
8
14
12
10
8
6
4
2
0
NCR Raised
87%
13%
98
85
13
35
Commercial Status
Cost Summary (AED)
Monthly Progress Report No. 7 - September 2014
244,747,598 8,177,509 - 226,116,726 479,041,833 37,437,524 1,899,214
20,000,000 7,738,272 - - 27,738,272 -
297,020 389,706 686,726 515,808
GHU 1,676,655
1,595,000 81,655 - - 1,676,655 - -
Payment Status (AED)
AED % AED % AED % AED
119,845,391 23.58% 115,383,973 22.7% 75,444,872 14.8% 63,693,496
21,989,206 79.3% 21,989,206 79.3% 21,436,431 77.3% 21,792,331
686,726 100.0% 618,053 90.0% 418,956 61.0% 618,053
1,403,119 83.7% 1,262,807 75.3% 1,355,221 80.8% 1,320,372
516479357.2
27738271.57
686726.1
* Note: The percentage value is the current amount divided by the Contract Price
ATC IPC# 39 (Aug-14) was considered for this report.
ATC
RMB
IGS
GHU
Variation Status 1676655
Variation
Approved
Cumulative Current Month
Variation
Rejected
Variation
DAMAC
Assessment
Variation
ATC
Assessment
Variation
Approved
Variation
Rejected
Variation
DAMAC
Assessment
35 9 9 26 0 0 0
Variation Value (AED)
Variation
Approved
Variation
Rejected
Variation
DAMAC
Assessment
Variation
ATC
Assessment
Variation
Approved
Variation
Rejected
Variation
DAMAC
Assessment
8,177,509 6,801,791 1,679,024 220,190

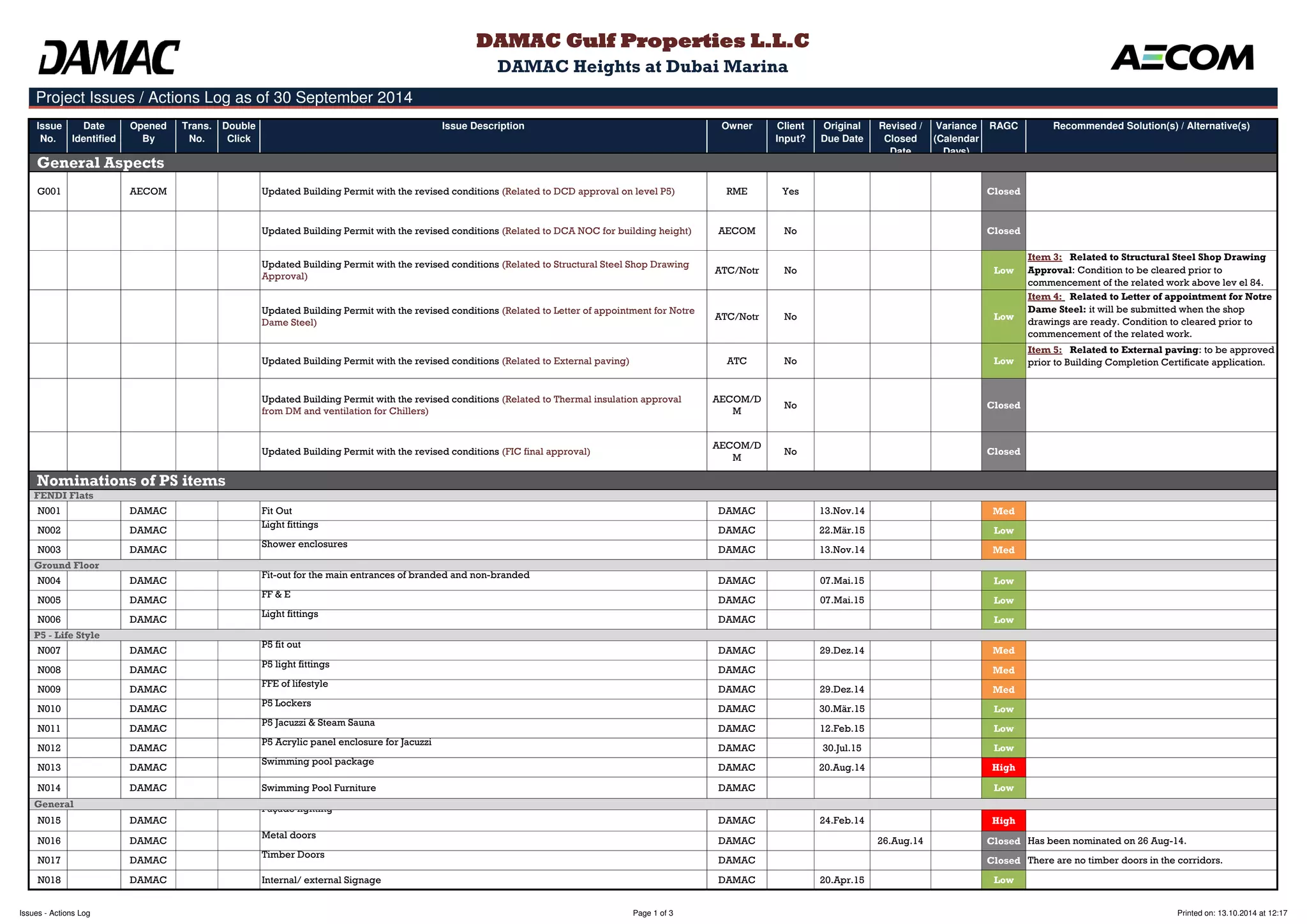

Key Commercial Issues
1
2
Monthly Progress Report No. 7 - September 2014 36
All Gross/Net Certified and Paid to Date Values excluded Advance Payments.
Item Management Strategy
Extension of Time Claims
EOT flooding claims are under review by 3rd party, anticipated closure in
October 2014.
ATC's Pending Variations Variations submission, assessment and approval continues.
Variation ATC
Assessment
ATC 0
Cumulative Current Month
Variation ATC
Assessment
ATC
12.53%
78.56%
95.29%
81.63%
Effective
Contract
Value
Approved
Variations
Approved
Claims
Approved PS
Total
Commitments
Residual
PS
Pending
Variations
Estimate at
Completion
ATC 518,378,571
RMB 27,738,272
IGS 1,202,534
Paid to Date
%
Gross Certified Net Certified Previously Certified
Cash Flow (AED,000)
1,300
1,200
1,100
1,000
900
800
700
600
500
400
300
200
100
Notice of Delays Under Review
Ref
.
Date Received
Delayed nomination of Elevators
Delayed nomination of MEP
Delayed nomination of Glazing
1 19-Feb-12
2 19-Feb-12
3 19-Feb-12
4 Delayed nomination of BMU
19-Feb-12
5 Delayed nomination of Façade Light
19-Feb-12
6 Delayed nomination of Sanitary Fittings
19-Feb-12
7 Delayed nomination of Home Automation
19-Feb-12
8 19-Feb-12
9 19-Feb-12
10 19-Feb-12
11 2-Apr-12
12 2-Apr-12
13 6-May-13
14 6-May-13
15 6-May-13
16 6-May-13
17 6-May-13
18 6-May-13
19 6-May-13
20 6-May-13
21 18-Aug-13
22 12-Feb-14
23 5-Mar-14
23.58
12.53
Delayed nomination of Kitchen Cabinet
Delayed nomination of Shower Enclosure ATC Total Variations
Delayed nomination of Timber Doors/Ironmongery Approved
Delayed nomination of Vanity Counter
Delayed nomination of Swimming Pool
Delayed nomination of Toilet Access.
Delayed nomination of Light Fittings
Delayed nomination of Roof Features Equipment
Delayed nomination of Fit out for Entrance
* Note: Only SC's nominations delays have mentioned.
Ref
.
35
ATC Total Variations
Rejected
Delayed nomination of Wardrobe, Vanaties
Delayed nomination of Mirrors
Delayed nomination of Landscape
Delayed nomination of Fit out for HC
Delayed nomination of Supply Porcelain/Ceramic Tiles
Item Date Received
No Claims closed to date -
ATC Total Variations
Delayed nomination of Fit out for Saunna,Steam and Pending
Delayed nomination of Fit out for Signage/Lockers
Claims Closed
ATC Gross % Certified
* Note: Cash flow will be produced after agreeing the target completion program.
Item ATC Paid % to Date
35
9
0
Monthly Planned
Monthly Actual
Cum. Planned
Cum. Actual
37
Risk Management
Top 7 Risks
RS_04
Risk Event Cause Risk Response
Delays in possessing
DEWA approval for LV
shop drawings and delays
in procuring LV Panels and
Bus Bars
Re-design of secondary
steel structure to support
the façade
Changes to the mechanical
floors arrangement and
absence of the design for
P5.
Monthly Progress Report No. 7 - September 2014
ALICO designed the secondary steel
structure. ATC to expidite submission
of fabrication drawings for approval in
order to place the material order.
DAMAC/R
ME
ATC
Risk ID Rating
Risk
Owner
DAMAC/
AECOM
RS_01
RS_02
Late of issuing MEP IFC
drawings.
RME to issue the final MEP IFC
drawings. Also the renewal of DEWA
design NOC to be done. On the other
hand an instruction to proceed with
procurment was issued by DAMAC.
Flooding in Zone B
Seepage through openings
in the existing diaphragm
walls.
Seepage occurred during September
2014 and AECOM will provide a
proposal for a permanent soluation to
the diaphragm wall.
ATC/
REMCO
RS_03
Delays in pouring the slab
of level 62
8 days estimated cycle will
not be achieved as the
core wall will need for 2
weeks at least.

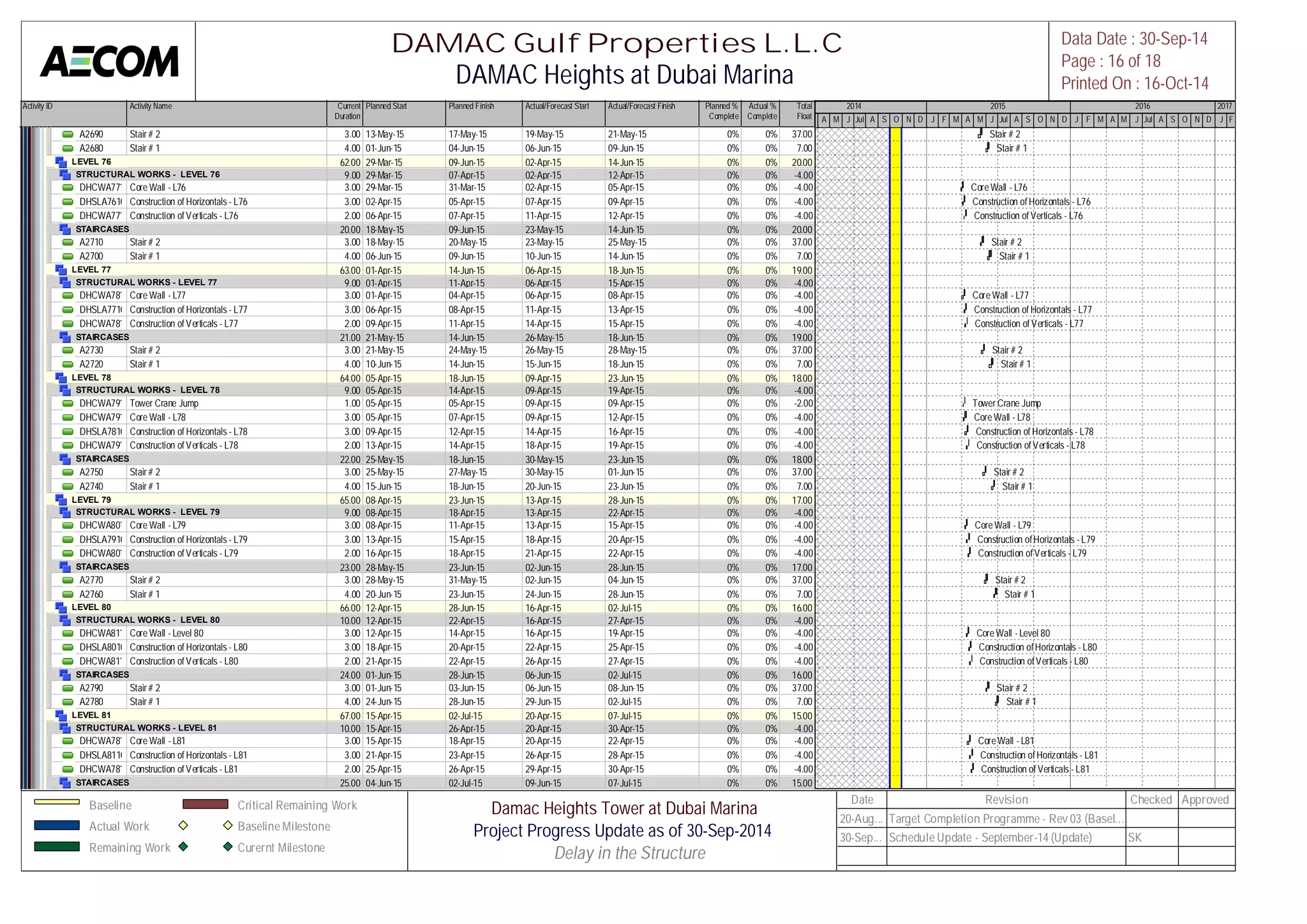

AECOM highlighted this issue to ATC in

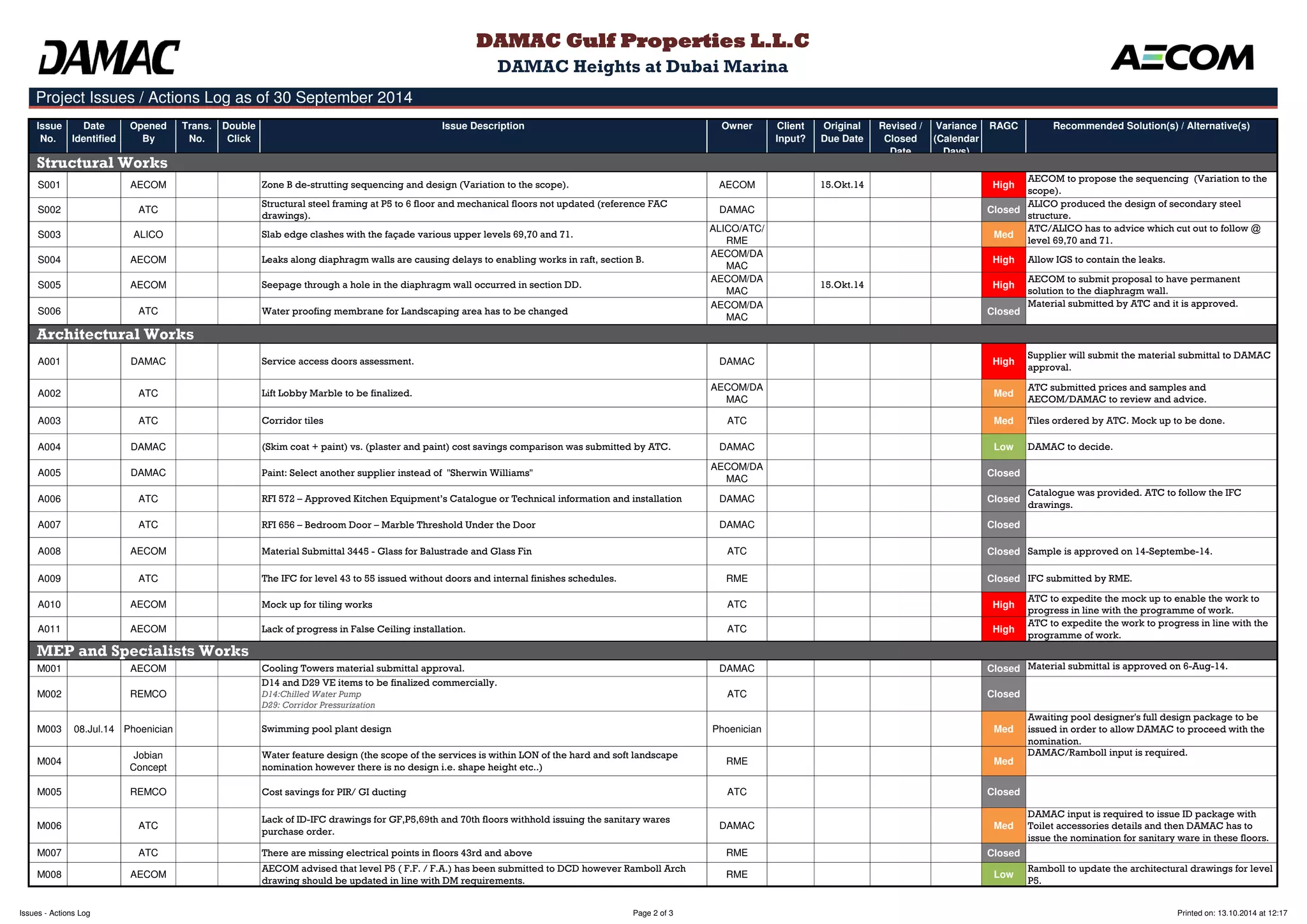

the weekly progress meeting,
however, no mitigation provided.
ATC
RS_05
Delays In MEP high level
installations, Concealed
Work and Risers Work
Delays from REMCO in
high level works
installation due to
insufficient of manpower.
REMCO to increase the allocated
manpower in order to work
concurrently in 5 levels.
RS_07 BMU Functionality
DAMAC
ALICO
RS_06
Delays in nomination of
the PS items
DAMAC's tenders
floating/awarding process
delayed.
DAMAC has to expedite the PS items'
procuring process in order to avoid
delaying the site works. Notably
façade light package.
There is no coordination
between the BMU and
Façade Designs.
Alico is doing the technical study.
Risk Rating Breakdown
5
4
3
2
1
0
Critical Severe Manageable Negligible
Critical
Severe
Manageable
Negligible
38
Core Values
into Practice
R
Monthly Progress Report No. 7 - September 2014
39
AECOM Core Values
'To enhance and sustain the world’s built, natural and social environments''
Monthly Progress Report No. 7 - September 2014
Growth
We recognize that our financial growth is the fairly earned result of living up to these
principles.
We earn and advance our reputation by delivering superior value on every project that we
undertake.
Our industry leadership depends on making project solutions more exciting,
sustainable and cost-effective.
We move with speed and dexterity to adapt and adjust to emerging client and project
requirements.
9 Core Values
We succeed by doing things the right way, with respect to ethics, laws, standards of
quality, and each other.
Employees
Our product is our people — our knowledge, skills, passion and diversity. Our success
begins with valuing our people and fostering their development.
We succeed by making our clients successful. We embrace our clients’ challenges
and opportunities and work for their success.
Whether in an office or on a construction site, keeping our people safe is our most
important measure of success.
Clients
Excellence
Innovation
Safety
Integrity
Agility
File :- Printed On :- 16.10.2014 at 10:38
40

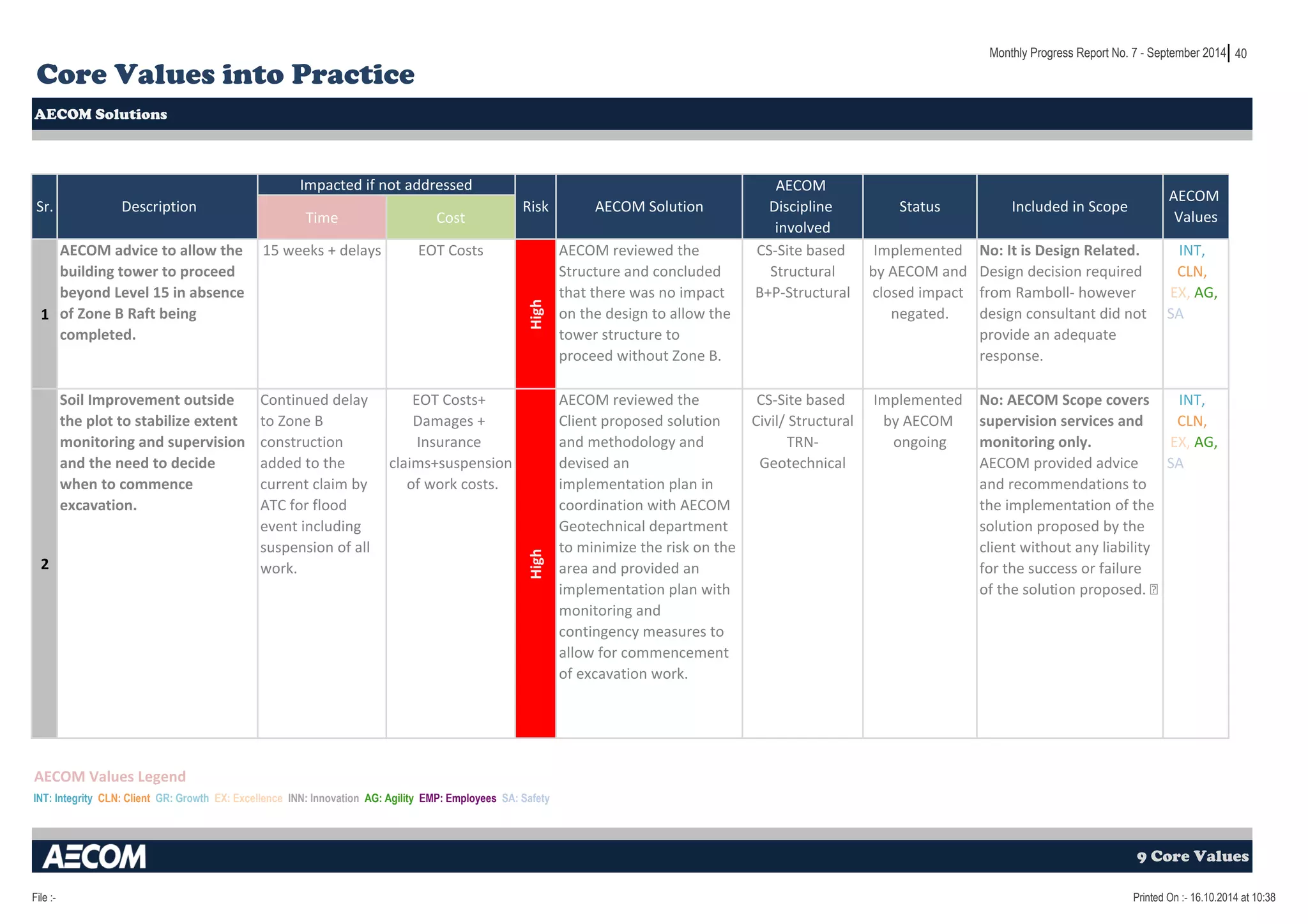

Core Values into Practice
AECOM Solutions
Time Cost
1
AECOM advice to allow the
building tower to proceed
beyond Level 15 in absence
of Zone B Raft being
completed.
15 weeks + delays EOT Costs
High
AECOM reviewed the
Structure and concluded
that there was no impact
on the design to allow the
tower structure to
proceed without Zone B.
CS-Site based
Structural
B+P-Structural
Implemented
by AECOM and
closed impact
negated.
No: It is Design Related.
Design decision required
from Ramboll- however
design consultant did not
provide an adequate
response.
INT,
CLN,
EX, AG,
SA
2
Soil Improvement outside
the plot to stabilize extent
monitoring and supervision
and the need to decide
when to commence
excavation.
Continued delay
to Zone B
construction
added to the
current claim by
ATC for flood
event including
suspension of all
work.
EOT Costs+
Damages +
Insurance
claims+suspension
of work costs.
High
AECOM reviewed the
Client proposed solution
and methodology and
devised an
implementation plan in
coordination with AECOM
Geotechnical department
to minimize the risk on the
area and provided an
implementation plan with
monitoring and
contingency measures to
allow for commencement
of excavation work.
CS-Site based
Civil/ Structural
TRN-Geotechnical
Implemented
by AECOM
ongoing
No: AECOM Scope covers
supervision services and
monitoring only.
AECOM provided advice
and recommendations to
the implementation of the
solution proposed by the
client without any liability
for the success or failure
of the solution proposed.

INT,
CLN,
EX, AG,
SA
AECOM Values Legend
Monthly Progress Report No. 7 - September 2014
Sr. Description
Impacted if not addressed
Risk AECOM Solution
AECOM
Discipline
involved
Status Included in Scope
AECOM
Values
INT: Integrity CLN: Client GR: Growth EX: Excellence INN: Innovation AG: Agility EMP: Employees SA: Safety
9 Core Values
File :- Printed On :- 16.10.2014 at 10:38
41
Core Values into Practice
AECOM Solutions
Time Cost

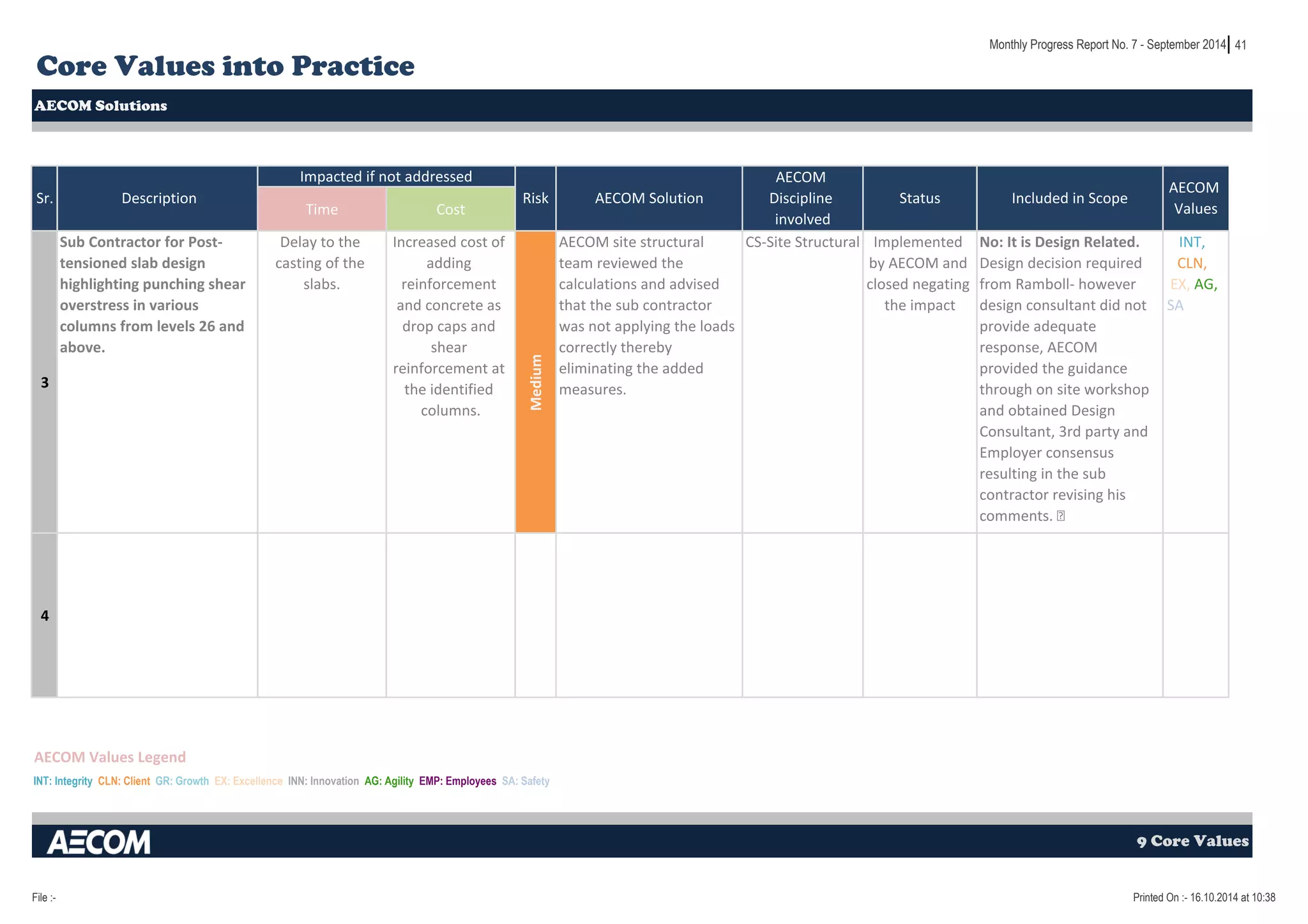

3
Sub Contractor for Post-tensioned
slab design
highlighting punching shear
overstress in various
columns from levels 26 and
above.
Delay to the
casting of the
slabs.
Increased cost of
adding
reinforcement
and concrete as
drop caps and
shear
reinforcement at
the identified
columns.
Medium
AECOM site structural
team reviewed the
calculations and advised
that the sub contractor
was not applying the loads
correctly thereby
eliminating the added
measures.
CS-Site Structural Implemented
by AECOM and
closed negating
the impact
Monthly Progress Report No. 7 - September 2014
No: It is Design Related.
Design decision required
from Ramboll- however
design consultant did not
provide adequate
response, AECOM
provided the guidance
through on site workshop
and obtained Design
Consultant, 3rd party and
Employer consensus
resulting in the sub
contractor revising his
comments.

INT,
CLN,
EX, AG,
SA
4
AECOM Values Legend
Included in Scope
AECOM
Values
INT: Integrity CLN: Client GR: Growth EX: Excellence INN: Innovation AG: Agility EMP: Employees SA: Safety
9 Core Values
Sr. Description
Impacted if not addressed
Risk AECOM Solution
AECOM
Discipline
involved
Status
File :- Printed On :- 16.10.2014 at 10:38
42
Appendices
R
Monthly Progress Report No. 7 - September 2014
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 1

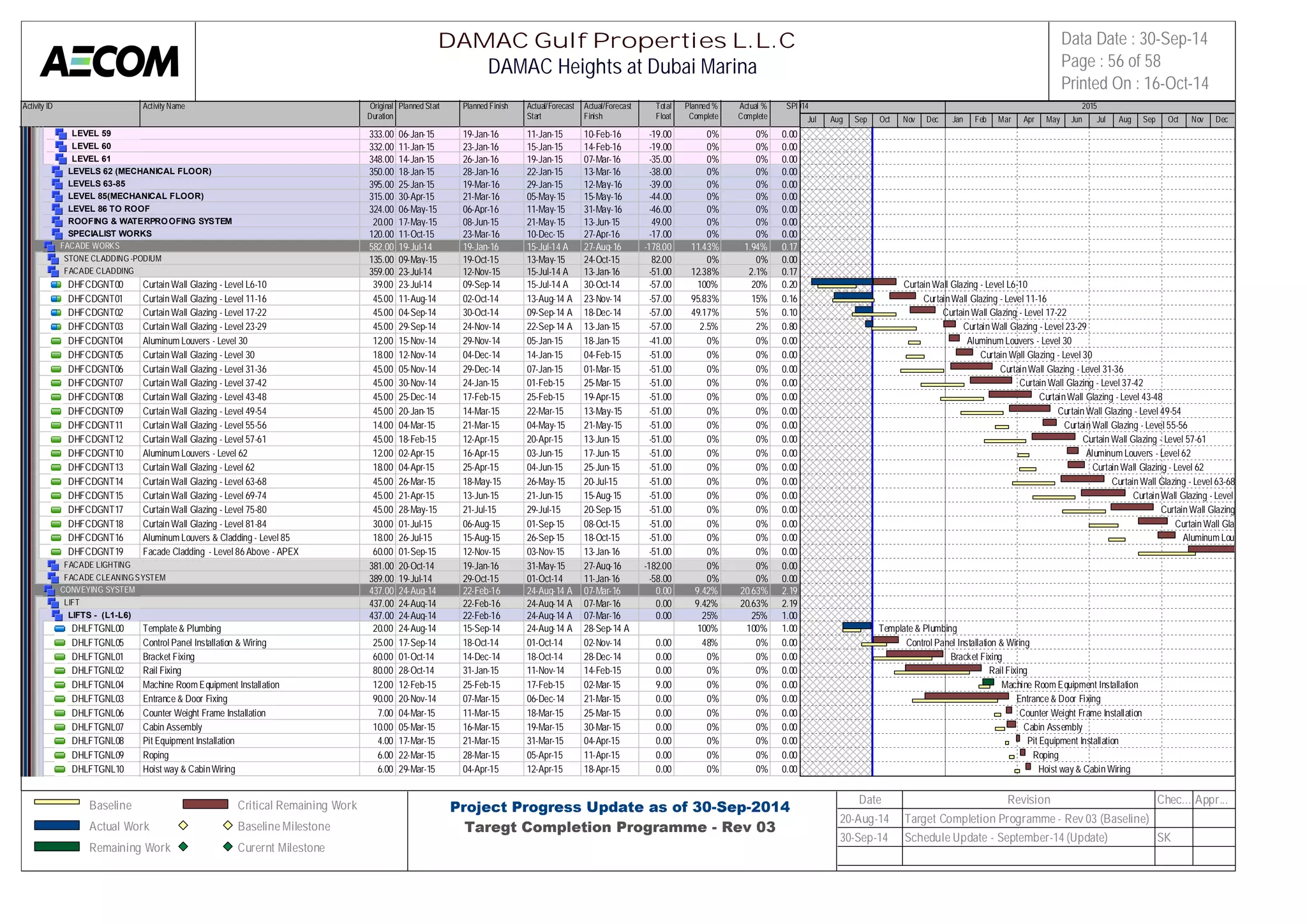

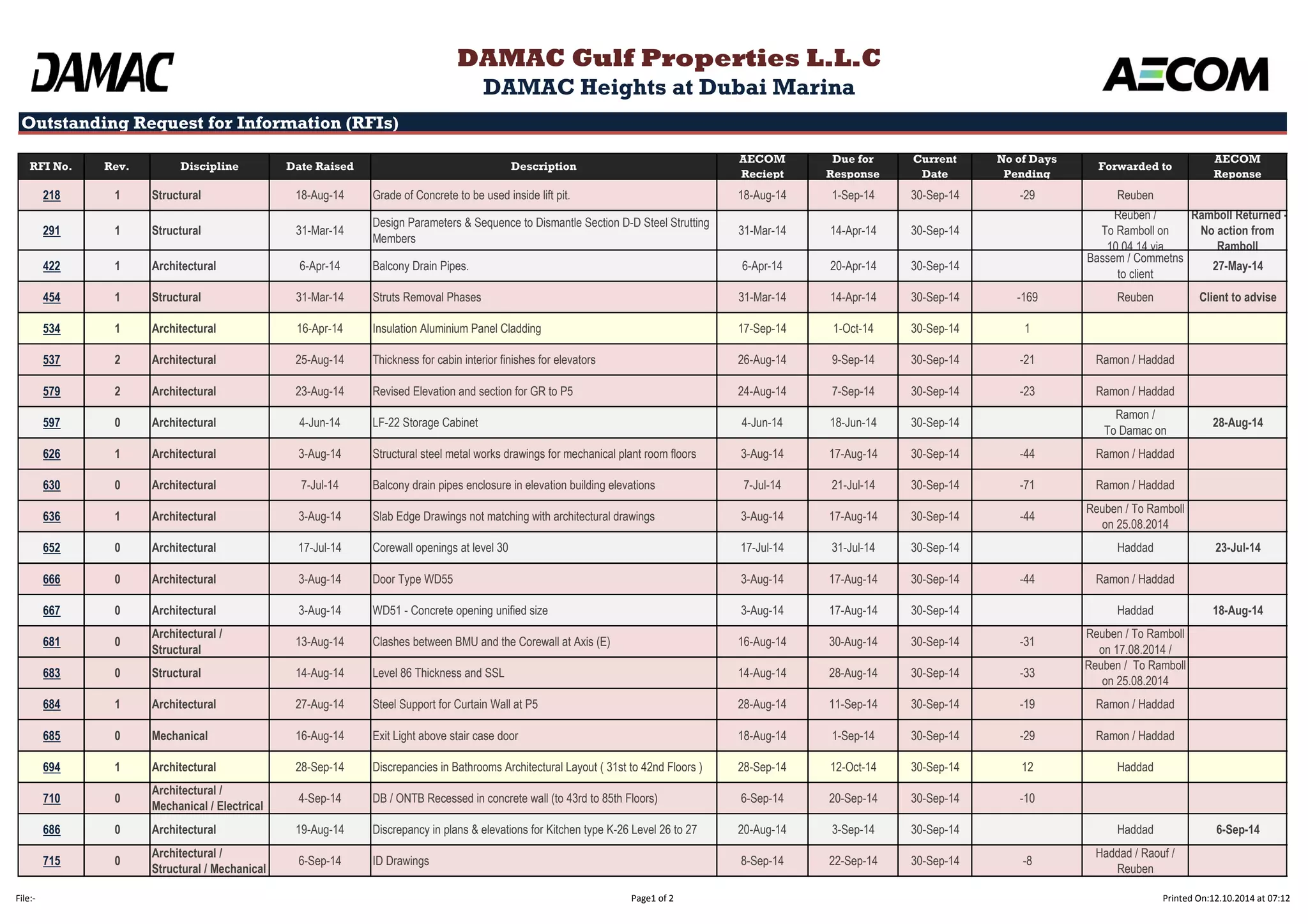

Schedule Update

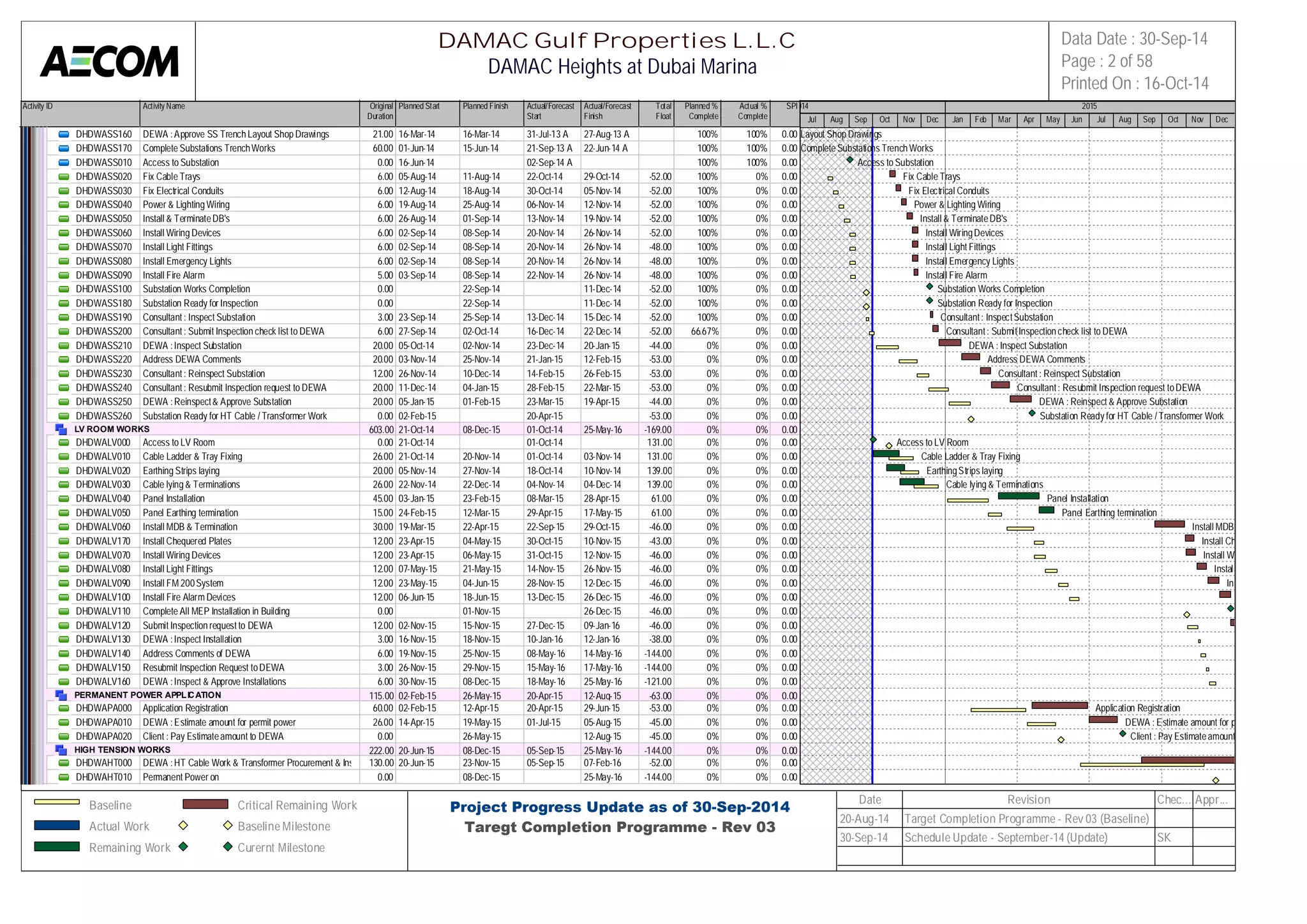

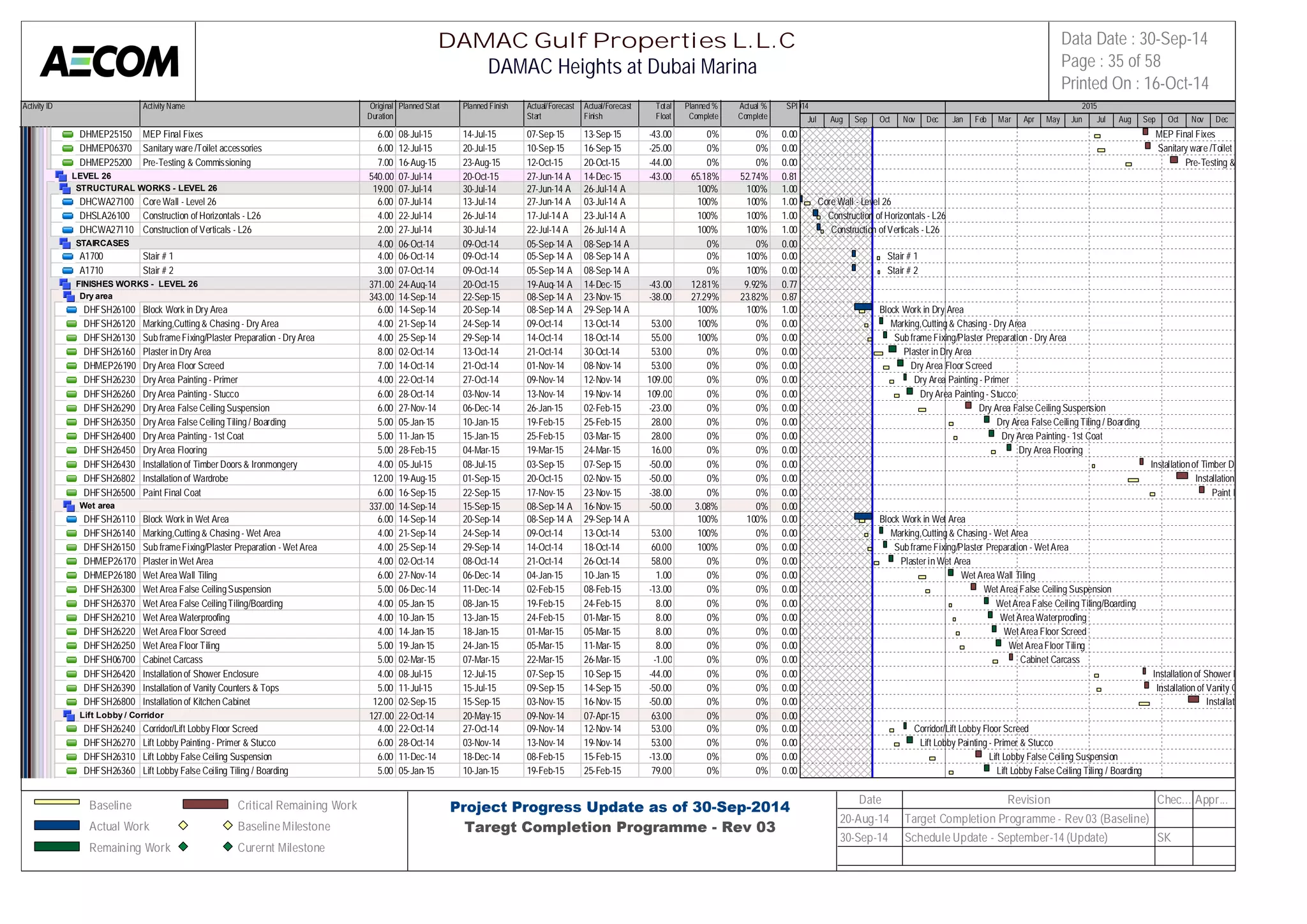

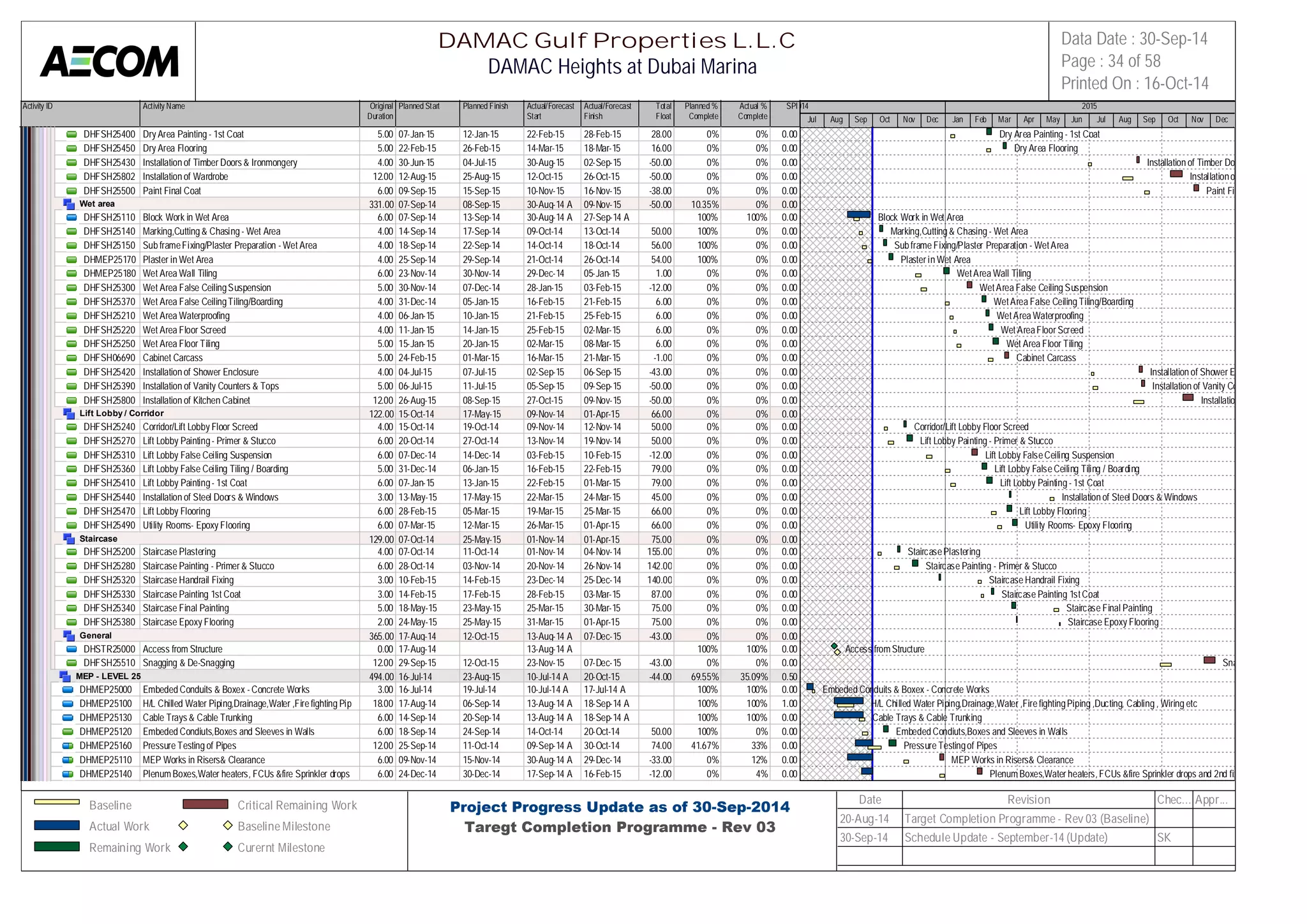

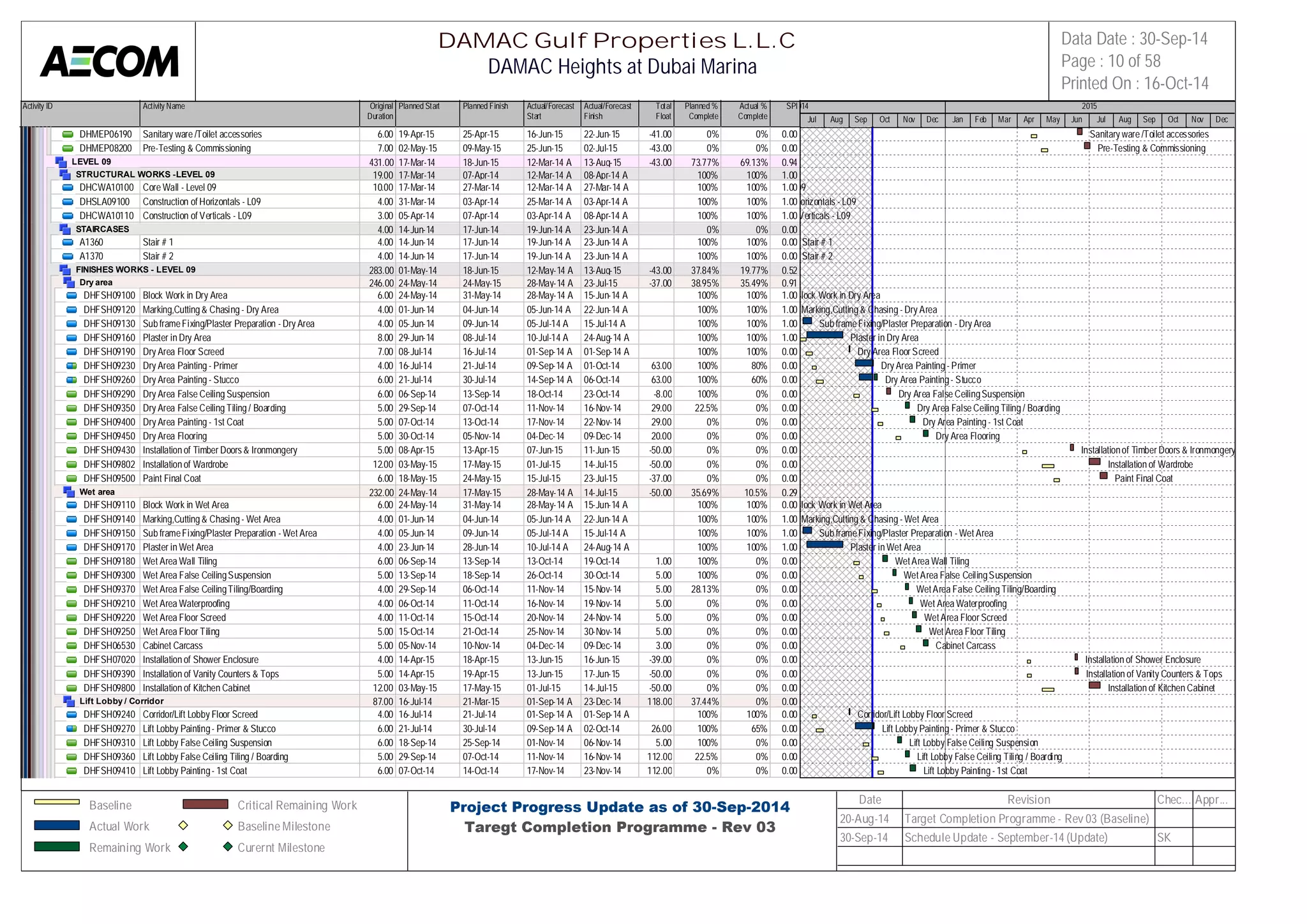

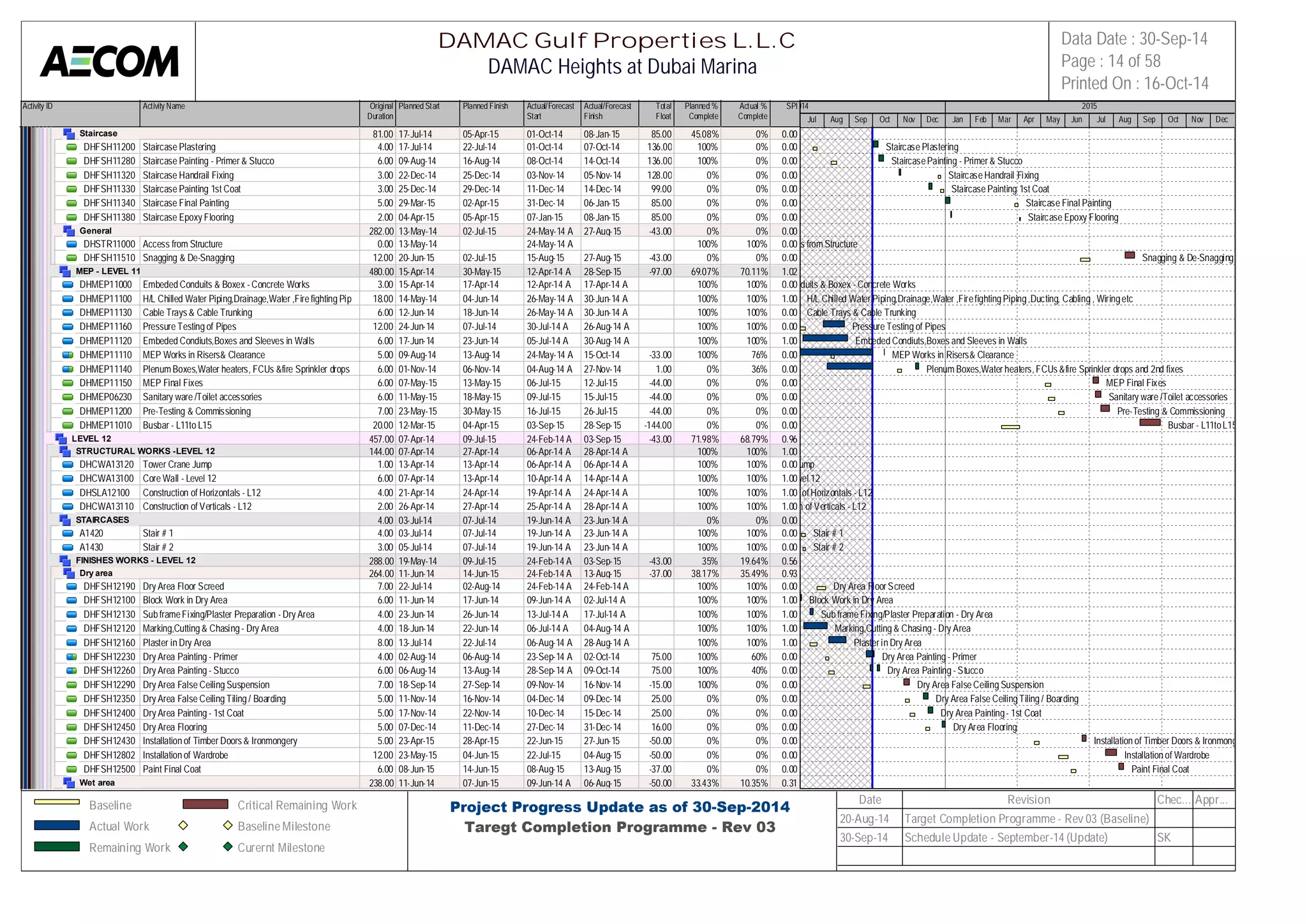

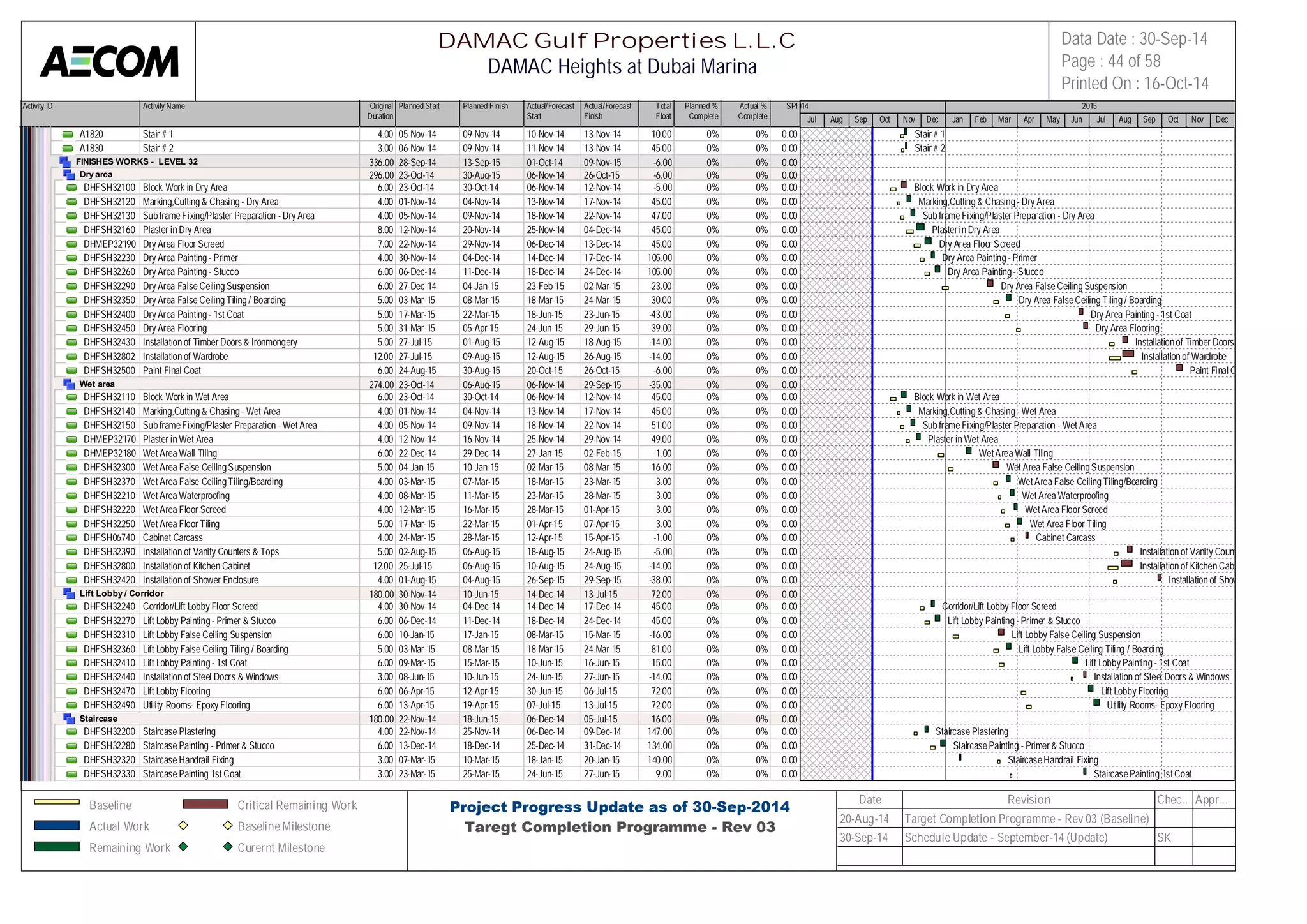

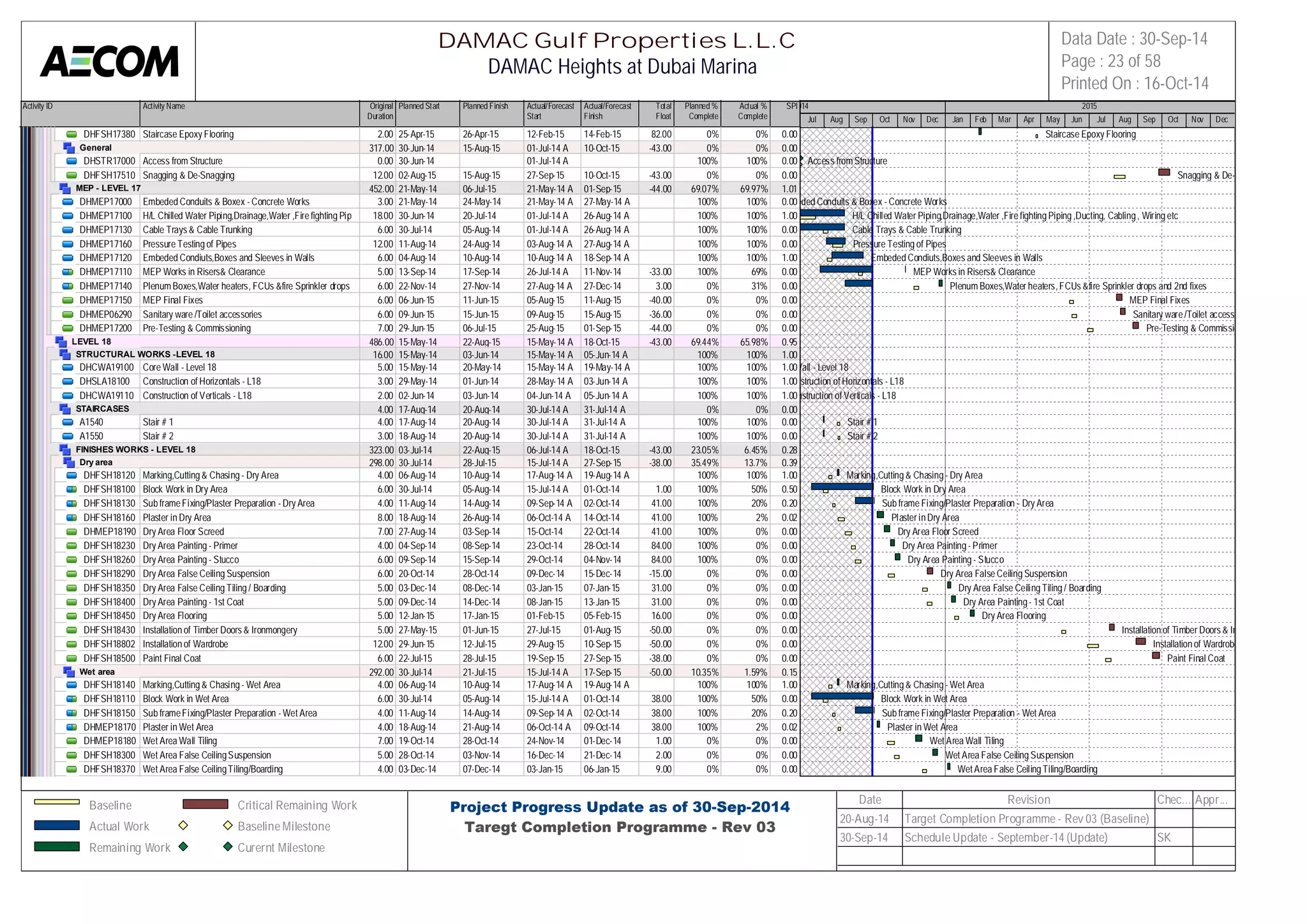

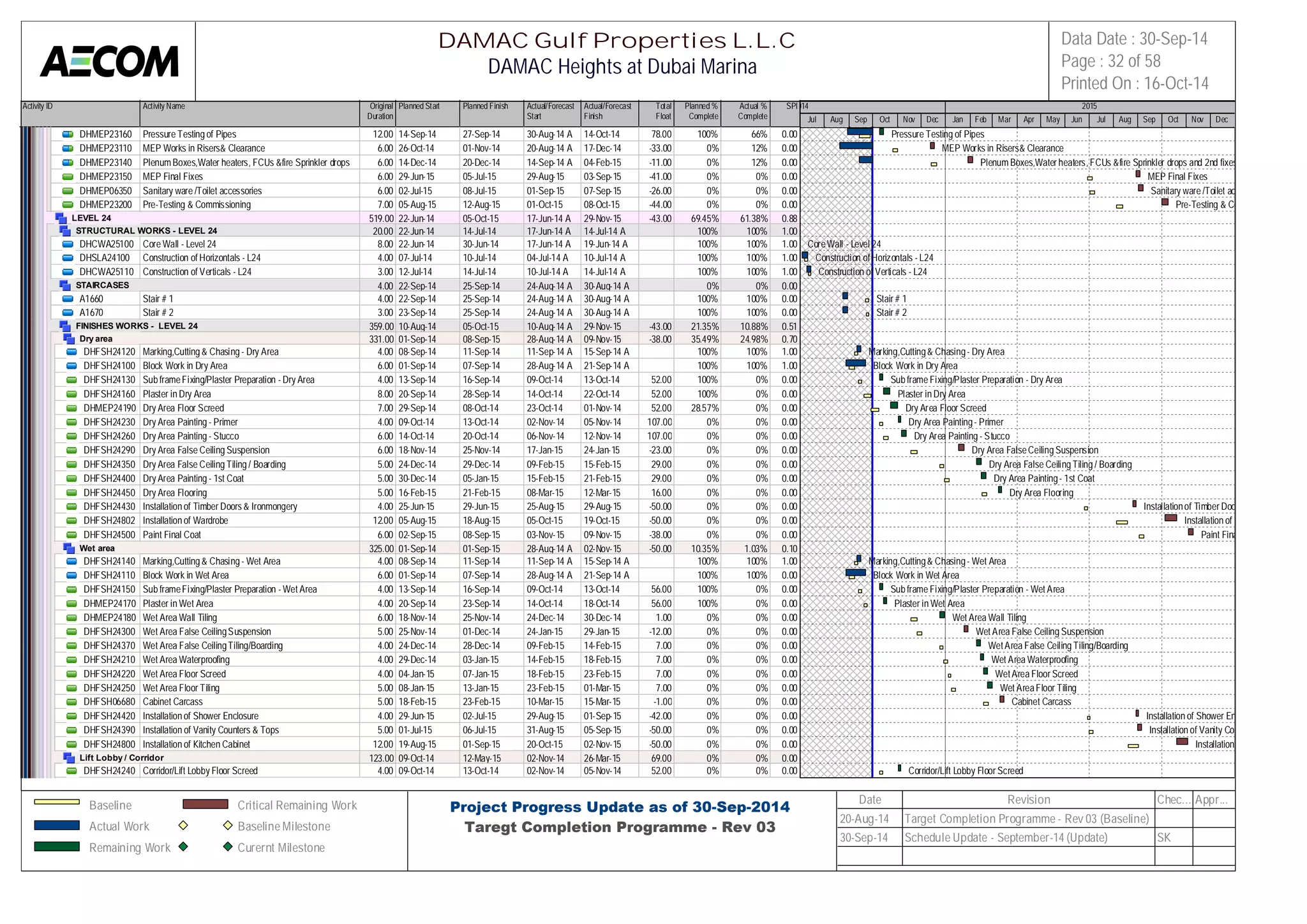

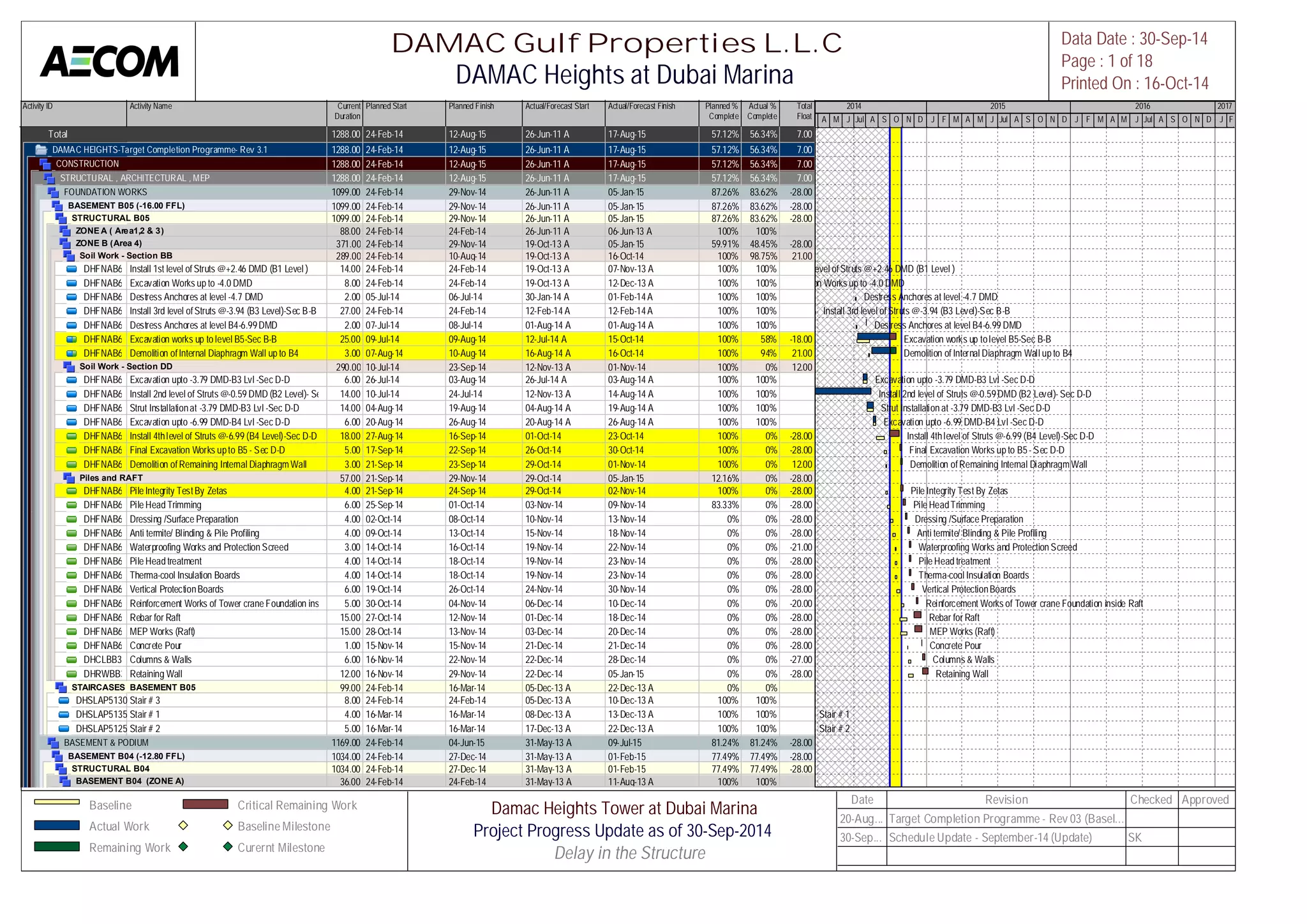

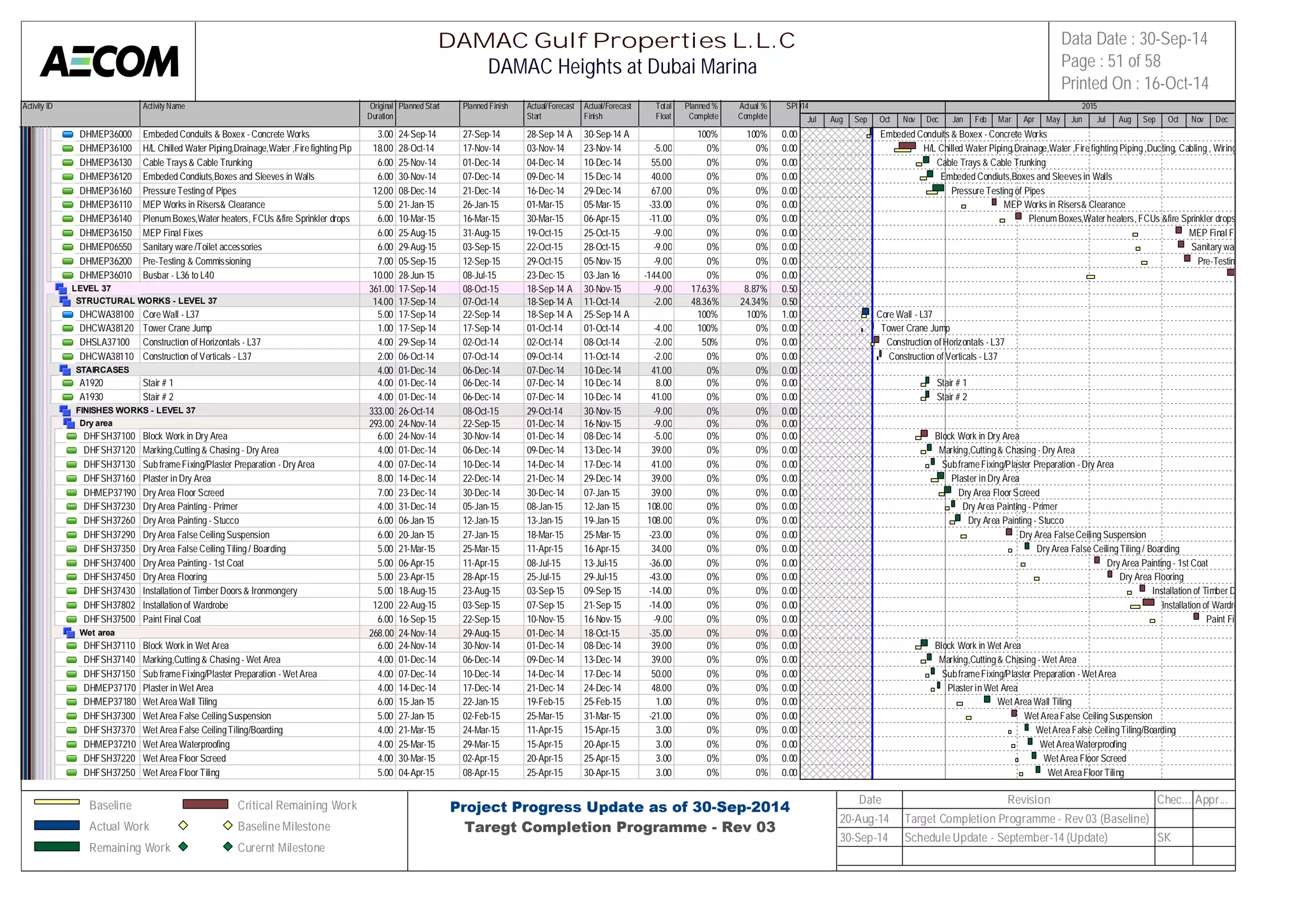

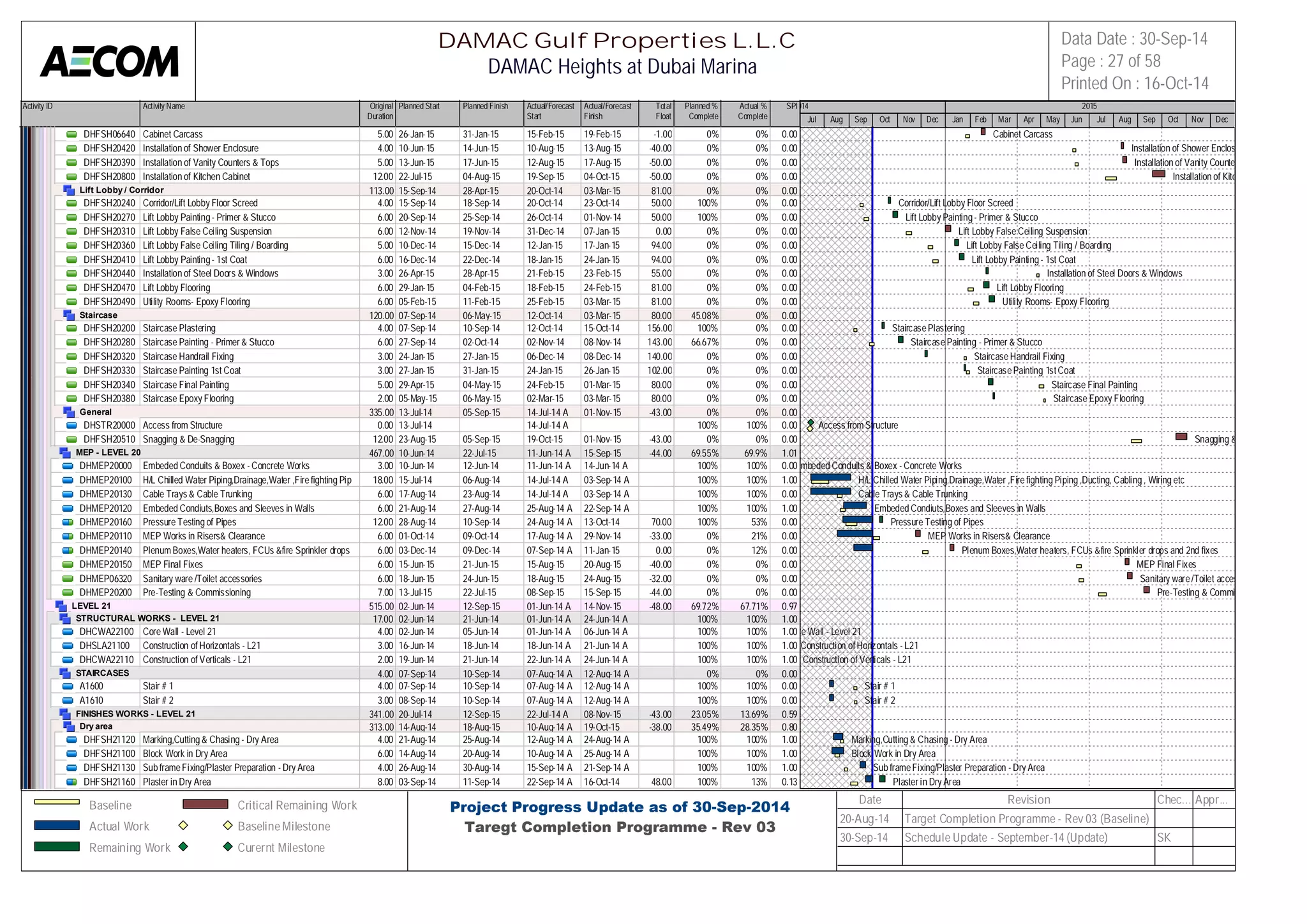

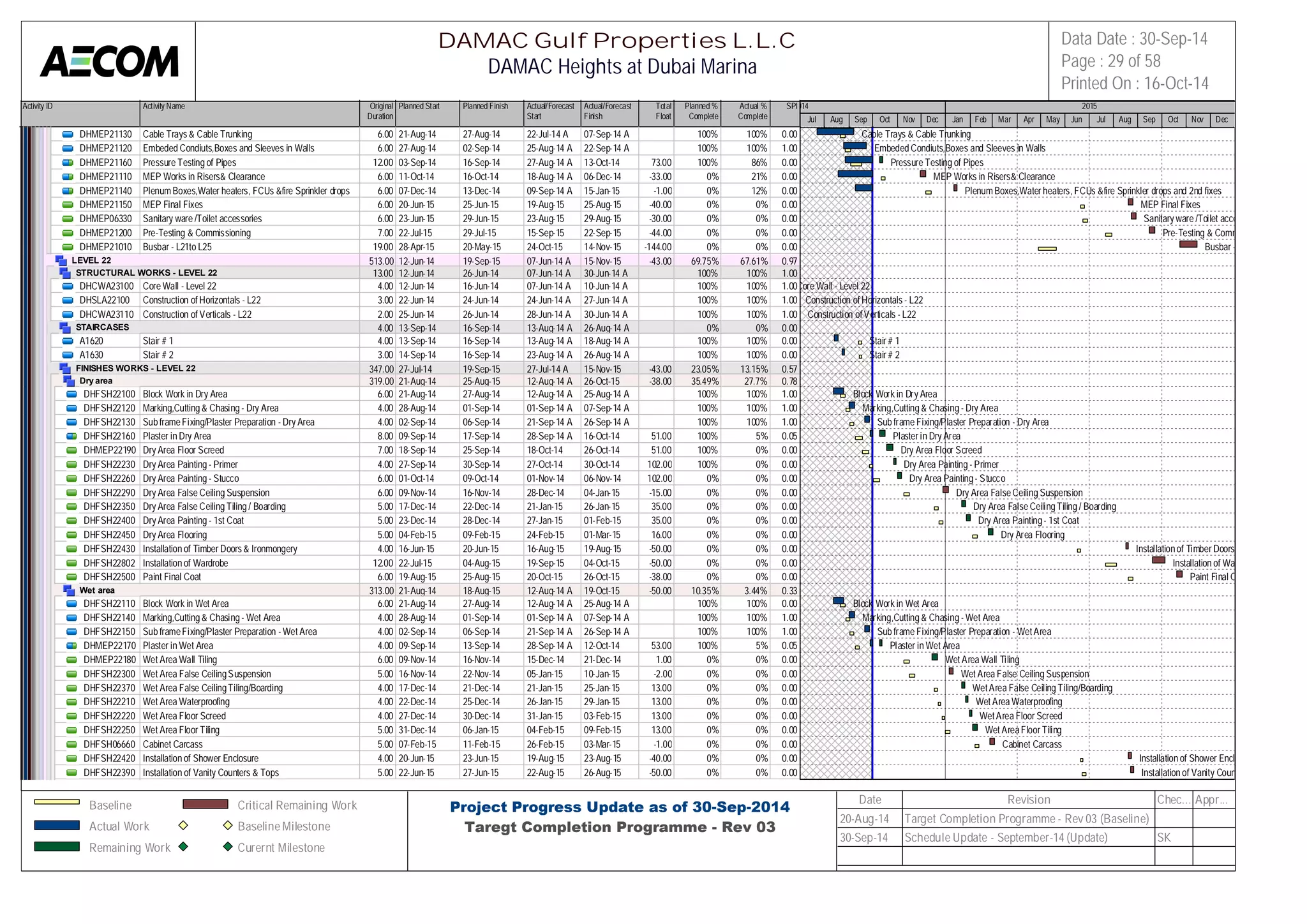

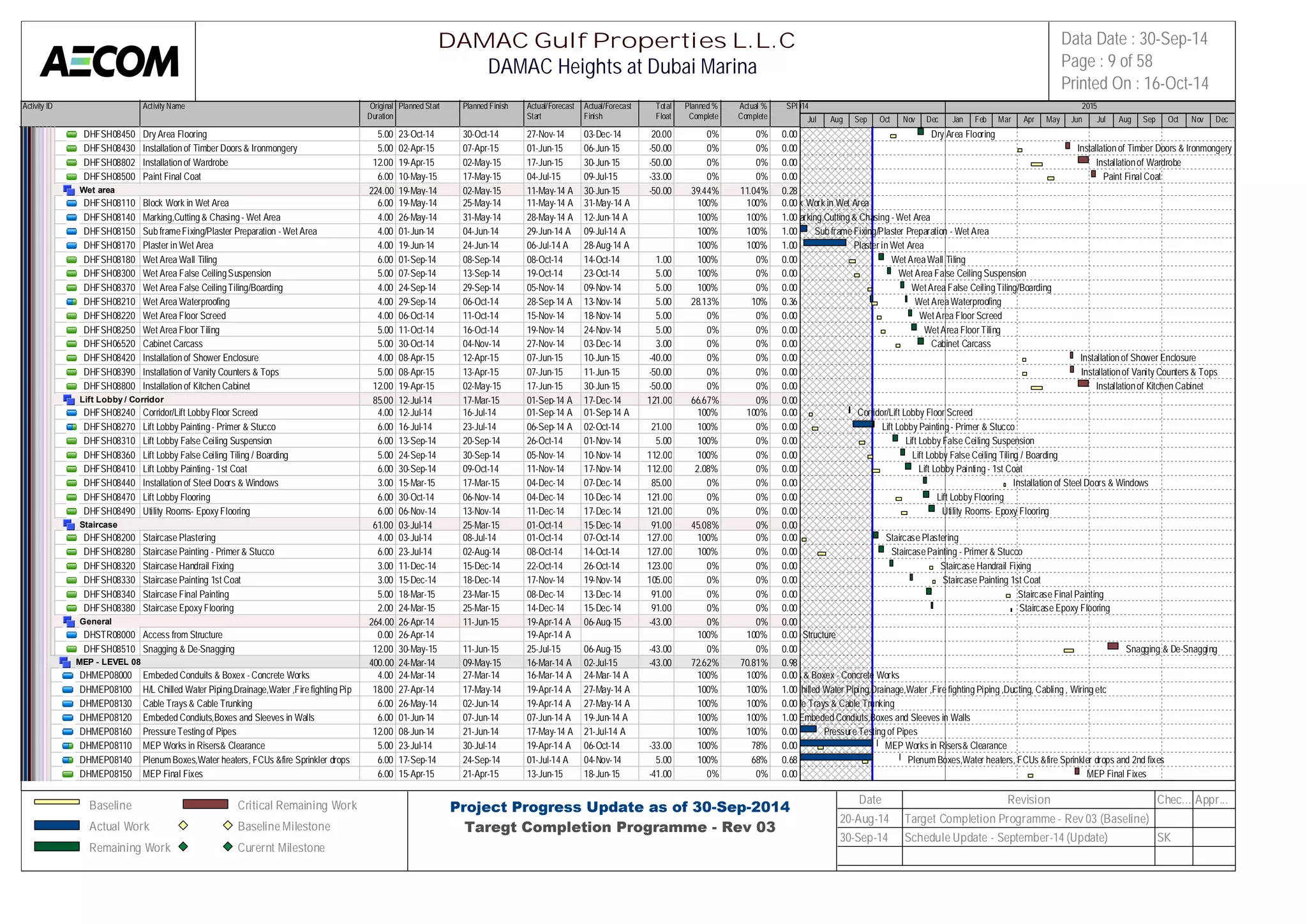

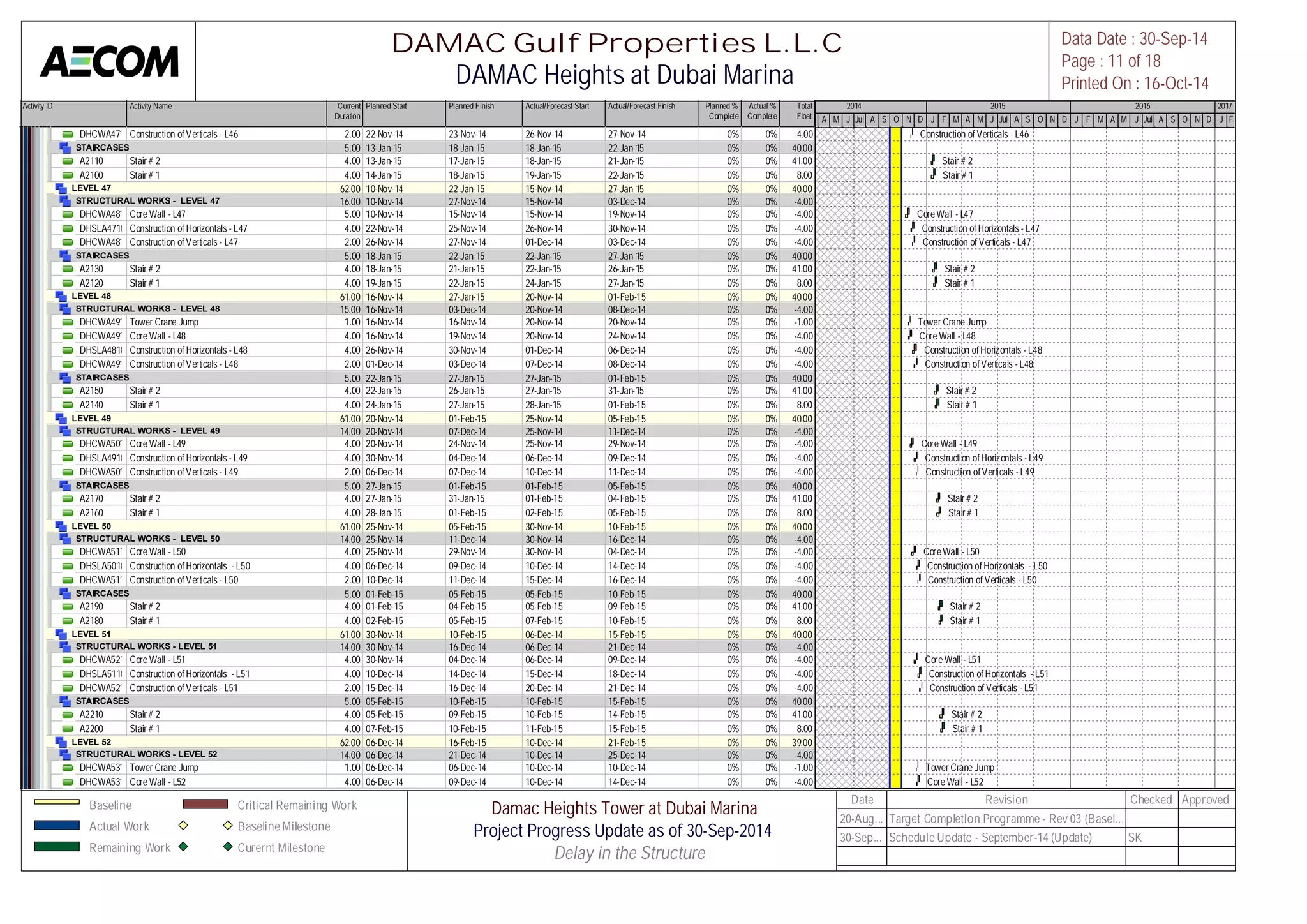

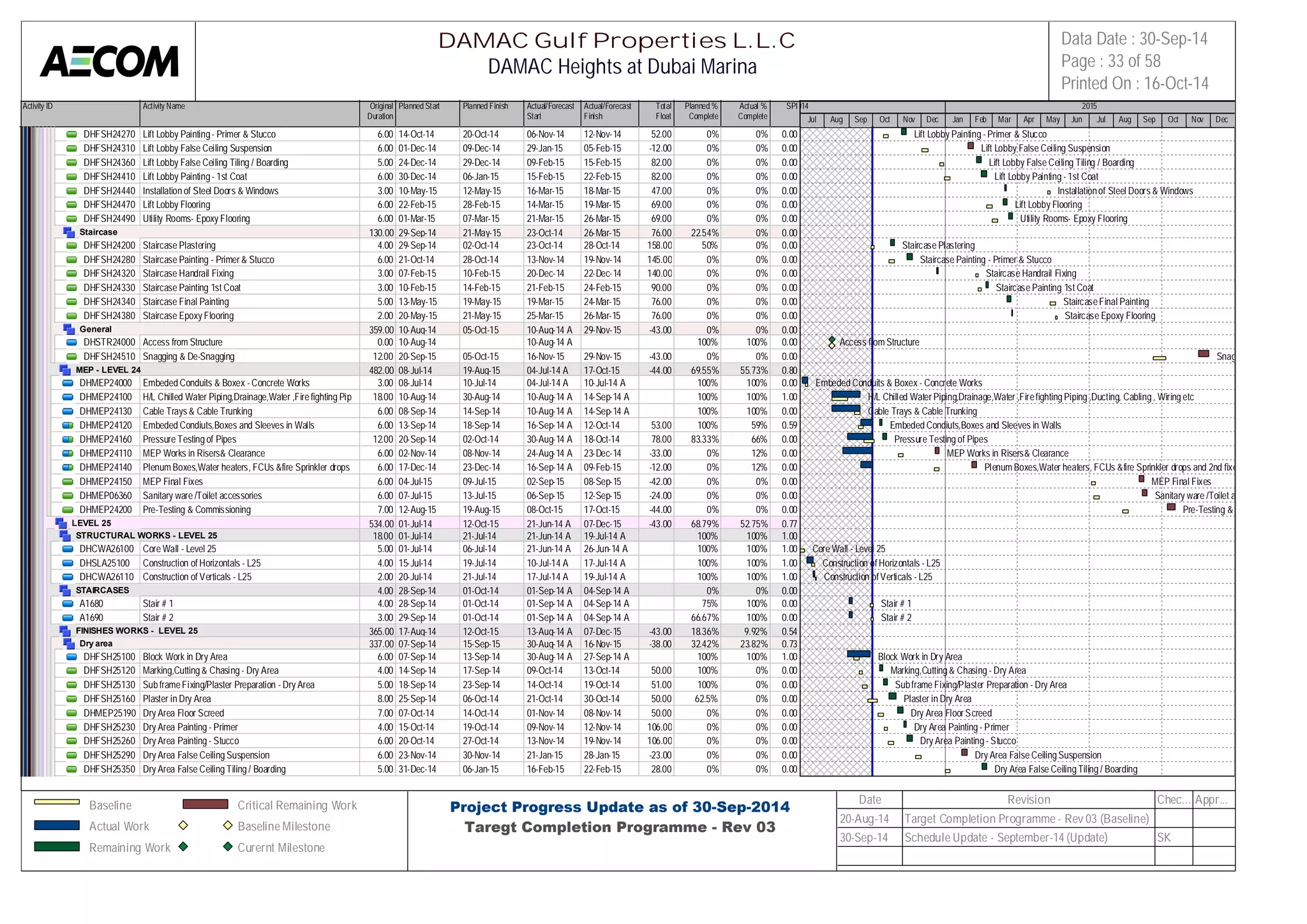

Activity ID Activity Name Original
Duration
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
Total 2012.00 24-Feb-14 14-May-16 05-Jun-11 A 20-Dec-16 -220.00 25.15% 22.46% 0.89
DAMAC HEIGHTS-Target Completion Programme- Rev 3.1 2012.00 24-Feb-14 14-May-16 05-Jun-11 A 20-Dec-16 -220.00 25.15% 22.46% 0.89
GENERAL 2012.00 24-Feb-14 14-May-16 05-Jun-11 A 20-Dec-16 -220.00 100% 0% 0.00
KEY DATES 1700.00 15-Nov-14 14-May-16 05-Jun-11 A 20-Dec-16 -182.00 0% 0% 0.00
DHKMSGN220 IFC Drawing 0.00 05-Jun-11 A 100% 100% 0.00
DHKMSGN200 Commencement Date 0.00 19-Jun-11 A 100% 100% 0.00
DHKMSGN210 Site Possession 0.00 19-Jun-11 A 100% 100% 0.00
DHKMSGN250 DM Approval on enabling Work Completion 0.00 02-Oct-12 A 100% 100% 0.00
DHKMSGN260 Approval test results on Enabling Work items 0.00 02-Oct-12 A 100% 100% 0.00
DHKMSGN240 Dewatering System Handing Over 0.00 22-Oct-12 A 100% 100% 0.00
DHKMSGN230 Building Permit 0.00 27-Mar-13 A 100% 100% 0.00
DHKMSGN470 Design Nocs 0.00 18-Apr-13 A 100% 100% 0.00
DHKMSGN410 Tower Raft Pour 0.00 17-May-13 A 100% 100% 0.00
DHKMSGN420 Overall Foundation Completion 0.00 15-Nov-14 21-Dec-14 -28.00 0% 0% 0.00
DHKMSGN430 Basement/Podium Completion of Structure up to GF 0.00 19-Feb-15 26-Mar-15 -28.00 0% 0% 0.00
DHKMSGN400 Partial Power On (Up to Lvl.30) 0.00 19-Feb-15 19-Apr-15 -50.00 0% 0% 0.00
DHKMSGN500 Wild Air On (Up to Lvl..29) 0.00 08-Mar-15 05-May-15 -50.00 0% 0% 0.00
DHKMSGN450 Podium Completion of Structure up to Lv. P5 0.00 04-Jun-15 09-Jul-15 -1.00 0% 0% 0.00
DHKMSGN402 Partial Power On (Lvl.31-61) 0.00 14-Jun-15 20-Jul-15 -14.00 0% 0% 0.00
DHKMSGN502 Wild Air On (Lvl.31-61) 0.00 21-Jul-15 06-Aug-15 -14.00 0% 0% 0.00
DHKMSGN452 Completion of Structure 0.00 12-Aug-15 17-Aug-15 7.00 0% 0% 0.00
DHKMSGN440 Completion of Facade Cladding Up to Lvl.85 0.00 15-Aug-15 18-Oct-15 -10.00 0% 0% 0.00
DHKMSGN462 Wild Air On (Level 62 above) 0.00 08-Nov-15 02-Jan-16 -46.00 0% 0% 0.00
DHKMSGN442 Completion of Facade Cladding Up to top 0.00 12-Nov-15 13-Jan-16 -5.00 0% 0% 0.00
DHKMSGN460 Permanent Power On (Overall) 0.00 08-Dec-15 25-May-16 -144.00 0% 0% 0.00
DHKMSGN990 Project Completion 0.00 14-May-16 20-Dec-16 -182.00 0% 0% 0.00
EMPLOYER KEY DATES 1756.00 07-Sep-14 19-Feb-16 15-Oct-12 A 30-Jun-16 -77.00 0% 0% 0.00
ISSUANCE OF VALID NOCs (BY OTHERS) 0.00 24-Feb-14 16-Mar-14 30-Sep-14 30-Sep-14 25.00 0% 0% 0.00
AUTHORITIES APPROVALS 1069.00 24-Feb-14 08-Mar-16 05-May-13 A 25-May-16 -63.00 100% 0% 0.00
DEWA POWER ON 1069.00 24-Feb-14 08-Mar-16 05-May-13 A 25-May-16 -63.00 100% 0% 0.00
SUB-STATION WORKS 1069.00 16-Mar-14 08-Dec-15 05-May-13 A 25-May-16 -169.00 100% 0% 0.00
LOAD SCHEDULE 100.00 18-Mar-14 24-Jul-14 18-Mar-14 A 19-Jan-15 -175.00 0% 0% 0.00
DHDWALS010 Prepare Shop Drawings 10.00 18-Mar-14 29-Mar-14 18-Mar-14 A 02-Oct-14 -145.00 100% 99% 0.00
DHDWALS020 Prepare Load Schedules 10.00 26-Mar-14 06-Apr-14 05-Apr-14 A 13-Oct-14 -145.00 100% 99% 0.00
DHDWALS090 Engineer's Review 14.00 07-Apr-14 20-Apr-14 20-May-14 A 14-Oct-14 -175.00 100% 99% 0.00
DHDWALS030 Submit Load Schedules to DEWA REV 00 5.00 20-Apr-14 26-Apr-14 15-Oct-14 20-Oct-14 -145.00 100% 0% 0.00
DHDWALS040 DEWA : Return Load Schedules with comments REV00 21.00 27-Apr-14 25-May-14 21-Oct-14 18-Nov-14 -122.00 100% 0% 0.00
DHDWALS050 Resubmit Load Schedules REV 01 5.00 26-May-14 30-May-14 19-Nov-14 23-Nov-14 -174.00 100% 0% 0.00
DHDWALS060 DEWA : Return Load Schedules with comments REV01 21.00 31-May-14 20-Jun-14 24-Nov-14 14-Dec-14 -174.00 100% 0% 0.00
DHDWALS070 Resubmit Load Schedules REV 02 5.00 21-Jun-14 25-Jun-14 15-Dec-14 20-Dec-14 -143.00 100% 0% 0.00
DHDWALS080 DEWA: Approve Load Schd. REV02 & Issue Const. NOC 21.00 26-Jun-14 24-Jul-14 21-Dec-14 19-Jan-15 -121.00 100% 0% 0.00
SUB-STATION WORKS 667.00 16-Mar-14 02-Feb-15 05-May-13 A 20-Apr-15 -62.00 100% 0% 0.00
DHDWASS110 Prepare Substation Trench Layout Shop Drg 45.00 16-Mar-14 16-Mar-14 05-May-13 A 21-Jun-13 A 100% 100% 0.00
DHDWASS120 Submit SS Trench Layout Shop Drg to DEWA 4.00 16-Mar-14 16-Mar-14 22-Jun-13 A 27-Jun-13 A 100% 100% 0.00
DHDWASS130 DEWA: Return Substation Layout Drg With Comments 12.00 16-Mar-14 16-Mar-14 28-Jun-13 A 09-Jul-13 A 100% 100% 0.00
DHDWASS140 Incorporate DEWA Comments in Shop Drgs 12.00 16-Mar-14 16-Mar-14 10-Jul-13 A 22-Jul-13 A 100% 100% 0.00
DHDWASS150 Resubmit SS Trench Layout Shop Drg to DEWA 6.00 16-Mar-14 16-Mar-14 23-Jul-13 A 30-Jul-13 A 100% 100% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Overall Foundation Completion
Basement/Podium Completion of Structure up to GF
Partial Power On (Up to Lvl.30)
Wild Air On (Up to Lvl..29)
Podium Completion of Structure up to Lv. P5
Partial Power On (Lvl.31-61)
Wild Air On (Lvl.31-61)
Completion of Structure
Completion of Facade Cladding Up Prepare Shop Drawings
Prepare Load Schedules
Engineer's Review
Submit Load Schedules to DEWA REV 00
DEWA : Return Load Schedules with comments REV00
Resubmit Load Schedules REV 01
DEWA : Return Load Schedules with comments REV01
Resubmit Load Schedules REV 02
DEWA: Approve Load Schd. REV02 & Issue Const. NOC
DEWA: Return Substation Layout Drg With Comments
Resubmit SS Trench Layout Shop Drg to DEWA
Data Date : 30-Sep-14
Page : 1 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK

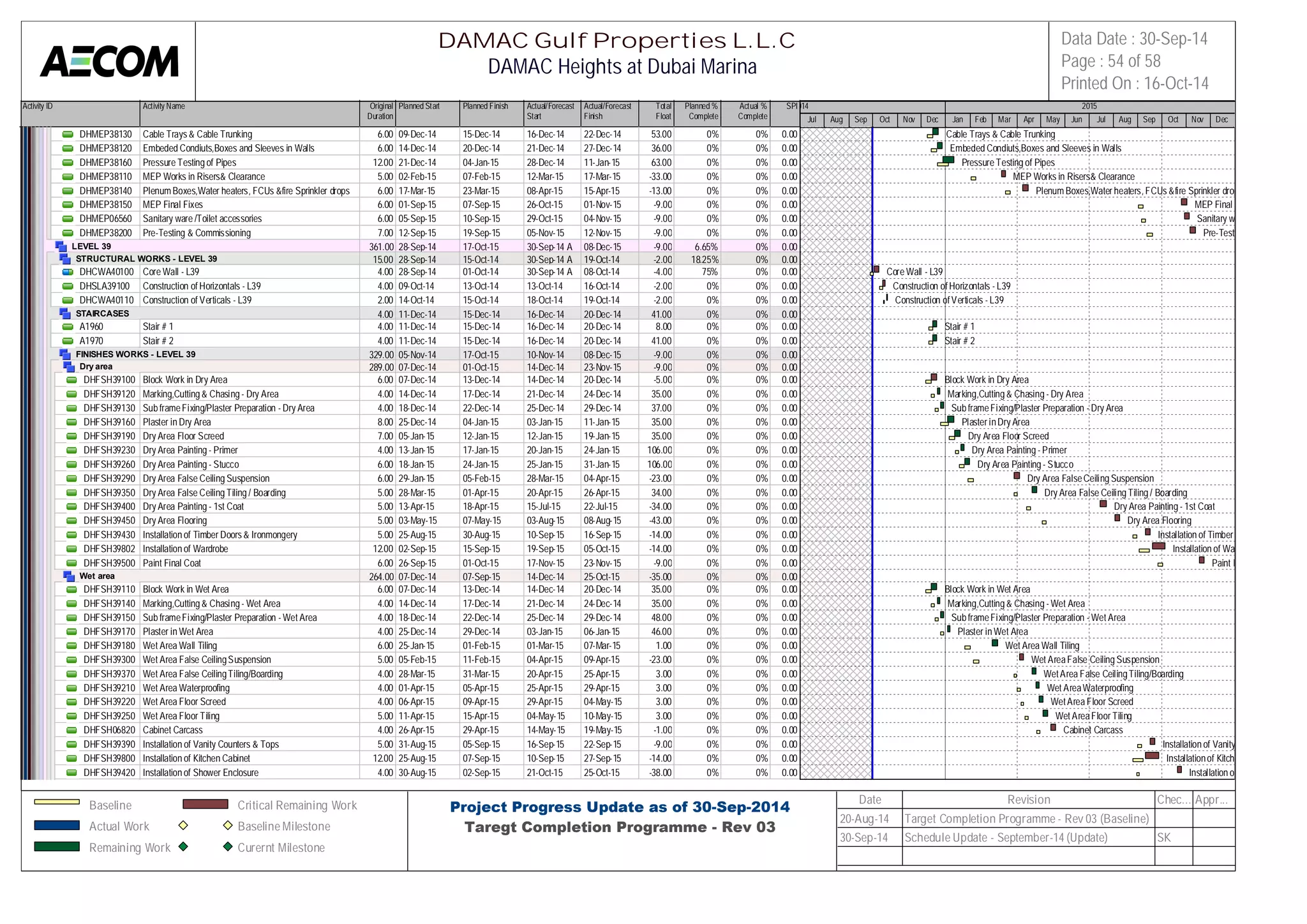

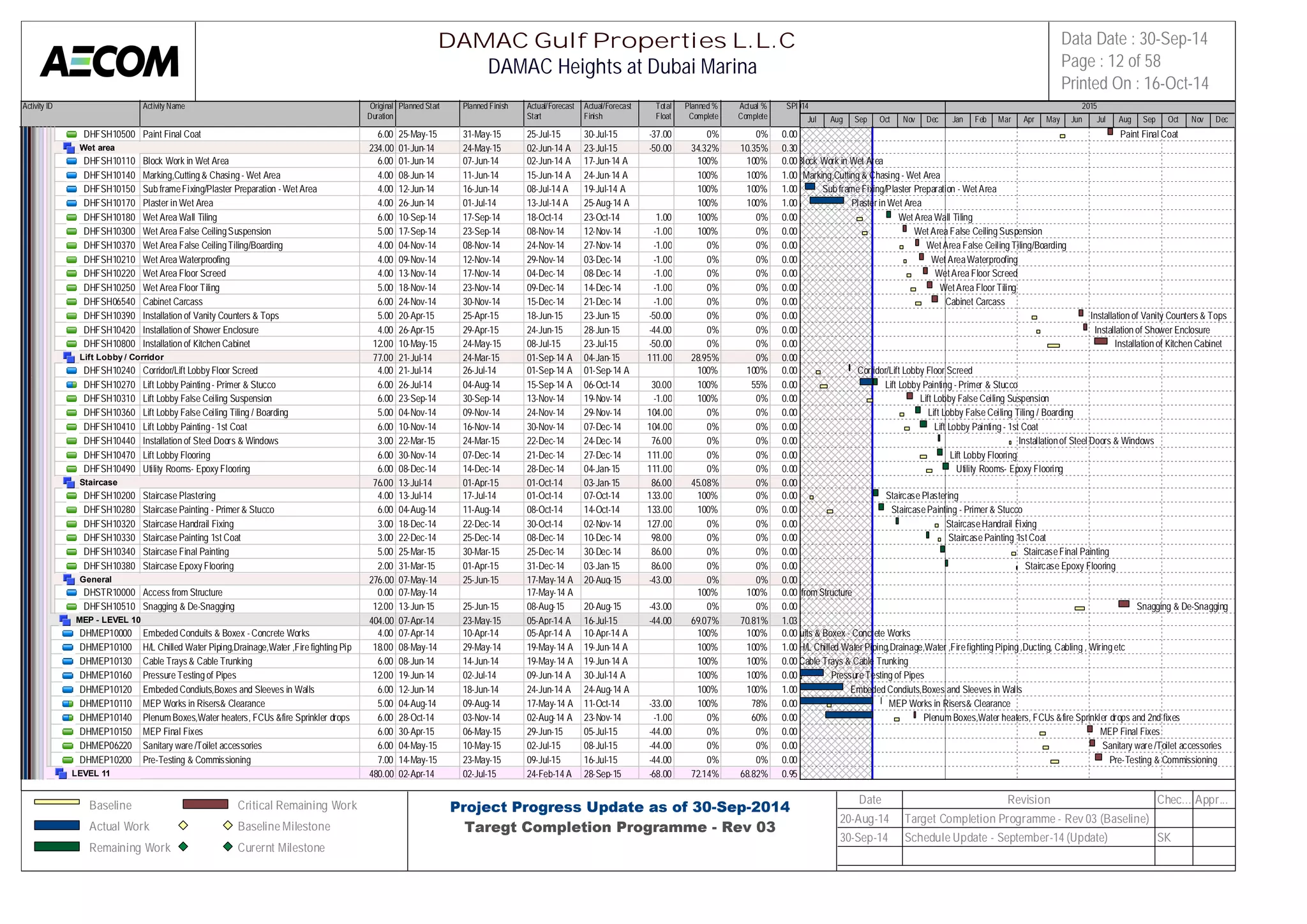

Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHDWASS160 DEWA : Approve SS Trench Layout Shop Drawings 21.00 16-Mar-14 16-Mar-14 31-Jul-13 A 27-Aug-13 A 100% 100% 0.00
DHDWASS170 Complete Substations Trench Works 60.00 01-Jun-14 15-Jun-14 21-Sep-13 A 22-Jun-14 A 100% 100% 0.00
DHDWASS010 Access to Substation 0.00 16-Jun-14 02-Sep-14 A 100% 100% 0.00
DHDWASS020 Fix Cable Trays 6.00 05-Aug-14 11-Aug-14 22-Oct-14 29-Oct-14 -52.00 100% 0% 0.00
DHDWASS030 Fix Electrical Conduits 6.00 12-Aug-14 18-Aug-14 30-Oct-14 05-Nov-14 -52.00 100% 0% 0.00
DHDWASS040 Power & Lighting Wiring 6.00 19-Aug-14 25-Aug-14 06-Nov-14 12-Nov-14 -52.00 100% 0% 0.00
DHDWASS050 Install & Terminate DB's 6.00 26-Aug-14 01-Sep-14 13-Nov-14 19-Nov-14 -52.00 100% 0% 0.00
DHDWASS060 Install Wiring Devices 6.00 02-Sep-14 08-Sep-14 20-Nov-14 26-Nov-14 -52.00 100% 0% 0.00
DHDWASS070 Install Light Fittings 6.00 02-Sep-14 08-Sep-14 20-Nov-14 26-Nov-14 -48.00 100% 0% 0.00
DHDWASS080 Install Emergency Lights 6.00 02-Sep-14 08-Sep-14 20-Nov-14 26-Nov-14 -48.00 100% 0% 0.00
DHDWASS090 Install Fire Alarm 5.00 03-Sep-14 08-Sep-14 22-Nov-14 26-Nov-14 -48.00 100% 0% 0.00
DHDWASS100 Substation Works Completion 0.00 22-Sep-14 11-Dec-14 -52.00 100% 0% 0.00
DHDWASS180 Substation Ready for Inspection 0.00 22-Sep-14 11-Dec-14 -52.00 100% 0% 0.00
DHDWASS190 Consultant : Inspect Substation 3.00 23-Sep-14 25-Sep-14 13-Dec-14 15-Dec-14 -52.00 100% 0% 0.00
DHDWASS200 Consultant : Submit Inspection check list to DEWA 6.00 27-Sep-14 02-Oct-14 16-Dec-14 22-Dec-14 -52.00 66.67% 0% 0.00
DHDWASS210 DEWA : Inspect Substation 20.00 05-Oct-14 02-Nov-14 23-Dec-14 20-Jan-15 -44.00 0% 0% 0.00
DHDWASS220 Address DEWA Comments 20.00 03-Nov-14 25-Nov-14 21-Jan-15 12-Feb-15 -53.00 0% 0% 0.00
DHDWASS230 Consultant : Reinspect Substation 12.00 26-Nov-14 10-Dec-14 14-Feb-15 26-Feb-15 -53.00 0% 0% 0.00
DHDWASS240 Consultant : Resubmit Inspection request to DEWA 20.00 11-Dec-14 04-Jan-15 28-Feb-15 22-Mar-15 -53.00 0% 0% 0.00
DHDWASS250 DEWA : Reinspect & Approve Substation 20.00 05-Jan-15 01-Feb-15 23-Mar-15 19-Apr-15 -44.00 0% 0% 0.00
DHDWASS260 Substation Ready for HT Cable / Transformer Work 0.00 02-Feb-15 20-Apr-15 -53.00 0% 0% 0.00
LV ROOM WORKS 603.00 21-Oct-14 08-Dec-15 01-Oct-14 25-May-16 -169.00 0% 0% 0.00
DHDWALV000 Access to LV Room 0.00 21-Oct-14 01-Oct-14 131.00 0% 0% 0.00
DHDWALV010 Cable Ladder & Tray Fixing 26.00 21-Oct-14 20-Nov-14 01-Oct-14 03-Nov-14 131.00 0% 0% 0.00
DHDWALV020 Earthing Strips laying 20.00 05-Nov-14 27-Nov-14 18-Oct-14 10-Nov-14 139.00 0% 0% 0.00
DHDWALV030 Cable lying & Terminations 26.00 22-Nov-14 22-Dec-14 04-Nov-14 04-Dec-14 139.00 0% 0% 0.00
DHDWALV040 Panel Installation 45.00 03-Jan-15 23-Feb-15 08-Mar-15 28-Apr-15 61.00 0% 0% 0.00
DHDWALV050 Panel Earthing termination 15.00 24-Feb-15 12-Mar-15 29-Apr-15 17-May-15 61.00 0% 0% 0.00
DHDWALV060 Install MDB & Termination 30.00 19-Mar-15 22-Apr-15 22-Sep-15 29-Oct-15 -46.00 0% 0% 0.00
DHDWALV170 Install Chequered Plates 12.00 23-Apr-15 04-May-15 30-Oct-15 10-Nov-15 -43.00 0% 0% 0.00
DHDWALV070 Install Wiring Devices 12.00 23-Apr-15 06-May-15 31-Oct-15 12-Nov-15 -46.00 0% 0% 0.00
DHDWALV080 Install Light Fittings 12.00 07-May-15 21-May-15 14-Nov-15 26-Nov-15 -46.00 0% 0% 0.00
DHDWALV090 Install FM 200 System 12.00 23-May-15 04-Jun-15 28-Nov-15 12-Dec-15 -46.00 0% 0% 0.00
DHDWALV100 Install Fire Alarm Devices 12.00 06-Jun-15 18-Jun-15 13-Dec-15 26-Dec-15 -46.00 0% 0% 0.00
DHDWALV110 Complete All MEP Installation in Building 0.00 01-Nov-15 26-Dec-15 -46.00 0% 0% 0.00
DHDWALV120 Submit Inspection request to DEWA 12.00 02-Nov-15 15-Nov-15 27-Dec-15 09-Jan-16 -46.00 0% 0% 0.00
DHDWALV130 DEWA : Inspect Installation 3.00 16-Nov-15 18-Nov-15 10-Jan-16 12-Jan-16 -38.00 0% 0% 0.00
DHDWALV140 Address Comments of DEWA 6.00 19-Nov-15 25-Nov-15 08-May-16 14-May-16 -144.00 0% 0% 0.00
DHDWALV150 Resubmit Inspection Request to DEWA 3.00 26-Nov-15 29-Nov-15 15-May-16 17-May-16 -144.00 0% 0% 0.00
DHDWALV160 DEWA : Inspect & Approve Installations 6.00 30-Nov-15 08-Dec-15 18-May-16 25-May-16 -121.00 0% 0% 0.00
PERMANENT POWER APPLICATION 115.00 02-Feb-15 26-May-15 20-Apr-15 12-Aug-15 -63.00 0% 0% 0.00
DHDWAPA000 Application Registration 60.00 02-Feb-15 12-Apr-15 20-Apr-15 29-Jun-15 -53.00 0% 0% 0.00
DHDWAPA010 DEWA : Estimate amount for permit power 26.00 14-Apr-15 19-May-15 01-Jul-15 05-Aug-15 -45.00 0% 0% 0.00
DHDWAPA020 Client : Pay Estimate amount to DEWA 0.00 26-May-15 12-Aug-15 -45.00 0% 0% 0.00
HIGH TENSION WORKS 222.00 20-Jun-15 08-Dec-15 05-Sep-15 25-May-16 -144.00 0% 0% 0.00
DHDWAHT000 DEWA : HT Cable Work & Transformer Procurement & Installat1io3n0.00 20-Jun-15 23-Nov-15 05-Sep-15 07-Feb-16 -52.00 0% 0% 0.00
DHDWAHT010 Permanent Power on 0.00 08-Dec-15 25-May-16 -144.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
DEWA : Approve SS Trench Layout Shop Drawings
Complete Substations Trench Works
Access to Substation
Fix Cable Trays
Fix Electrical Conduits
Power & Lighting Wiring
Install & Terminate DB's
Install Wiring Devices
Install Light Fittings
Install Emergency Lights
Install Fire Alarm
Substation Works Completion
Substation Ready for Inspection
Consultant : Inspect Substation
Consultant : Submit Inspection check list to DEWA
DEWA : Inspect Substation
Address DEWA Comments
Consultant : Reinspect Substation
Consultant : Resubmit Inspection request to DEWA
DEWA : Reinspect & Approve Substation
Substation Ready for HT Cable / Transformer Work
Access to LV Room
Cable Ladder & Tray Fixing
Earthing Strips laying
Cable lying & Terminations
Panel Installation
Panel Earthing termination
Install MDB & Termination
Install Chequered Plates
Install Wiring Devices
Install Light Fittings
Install FM 200 System
Application Registration
DEWA : Estimate amount for permit power
Client : Pay Estimate amount to DEWA
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 2 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DEWA WATER 567.00 03-Mar-14 08-Mar-16 26-Jan-14 A 12-Apr-16 -20.00 0% 0% 0.00
DUBAI CIVIL DEFENCE 104.00 27-Feb-14 06-Jul-14 24-Feb-14 A 24-Feb-14 A 0% 0% 0.00
CIVIL AVIATION 223.00 29-Oct-14 04-Jun-15 24-Feb-14 A 24-Feb-14 A 0% 0% 0.00
ETISALAT/ DU 383.00 03-Mar-14 14-Jul-15 24-Feb-14 A 11-Oct-15 66.00 0% 0% 0.00
DM DRAINAGE 567.00 24-Feb-14 08-Mar-16 24-Feb-14 A 12-Apr-16 -20.00 0% 0% 0.00
CONSTRUCTION EQUIPMENTS 1570.00 24-Feb-14 14-Nov-15 11-May-13 A 13-Jan-16 -60.00 0% 0% 0.00
ENGINEERING & PROCUREMENT 1843.00 24-Feb-14 07-Dec-15 19-Jun-11 A 02-Feb-16 128.00 0% 0% 0.00
PROVISIONAL SUMS 658.00 24-Feb-14 01-Oct-15 13-Aug-13 A 01-Oct-15 132.00 0% 0% 0.00
MEP LONG LEAD ITEMS 319.00 19-Mar-14 22-Jul-15 14-Jan-14 A 05-Oct-15 -29.00 0% 0% 0.00
Electrical 307.00 10-Jun-14 05-Apr-15 05-Mar-14 A 05-Oct-15 -46.00 0% 0% 0.00
Bus Bar 127.00 10-Jul-14 14-Jan-15 05-Mar-14 A 17-Jun-15 -128.00 0% 0% 0.00
A3260 Material Submittal 14.00 10-Jul-14 26-Jul-14 05-Mar-14 A 16-Apr-14 A 100% 100% 0.00
A3270 Material Approval 14.00 27-Jul-14 13-Aug-14 06-Mar-14 A 06-May-14 A 100% 100% 0.00
A3280 Issue of PO to Supplier 7.00 14-Aug-14 21-Aug-14 20-Jan-15 27-Jan-15 -128.00 100% 0% 0.00
A3290 Manufacturing /Procurement and Delivery of the Material 120.00 23-Aug-14 14-Jan-15 28-Jan-15 17-Jun-15 -128.00 28.33% 0% 0.00
Wiring Accessories 227.00 28-Oct-14 05-Apr-15 16-Apr-14 A 08-Feb-15 52.00 0% 0% 0.00
A3220 Material Submittal 14.00 28-Oct-14 12-Nov-14 16-Apr-14 A 18-May-14 A 0% 100% 0.00
A3230 Material Approval 14.00 13-Nov-14 29-Nov-14 17-Apr-14 A 02-Jun-14 A 0% 100% 0.00
A3240 Issue of PO to Supplier 7.00 30-Nov-14 08-Dec-14 01-Oct-14 11-Oct-14 52.00 0% 0% 0.00
A3250 Manufacturing /Procurement and Delivery of the Material 100.00 09-Dec-14 05-Apr-15 12-Oct-14 08-Feb-15 52.00 0% 0% 0.00
LV Panels & Switchgear 127.00 10-Jun-14 14-Dec-14 18-Mar-14 A 03-Mar-15 104.00 0% 0% 0.00
A3300 Material Submittal 14.00 10-Jun-14 25-Jun-14 18-Mar-14 A 01-May-14 A 100% 100% 0.00
A3310 Material Approval 14.00 26-Jun-14 12-Jul-14 19-Mar-14 A 15-May-14 A 100% 100% 0.00
A3320 Issue of PO to Supplier 7.00 13-Jul-14 20-Jul-14 01-Oct-14 11-Oct-14 104.00 100% 0% 0.00
A3330 Manufacturing /Procurement and Delivery of the Material 120.00 21-Jul-14 14-Dec-14 12-Oct-14 03-Mar-15 104.00 50% 0% 0.00
Generator 193.00 15-Jul-14 30-Mar-15 24-Aug-14 A 05-Oct-15 -46.00 0% 0% 0.00
A3340 Material Submittal 14.00 15-Jul-14 02-Aug-14 24-Aug-14 A 19-Feb-15 -46.00 100% 78.57% 0.00
A3350 Material Approval 14.00 03-Aug-14 18-Aug-14 25-Aug-14 A 23-Feb-15 -46.00 100% 78.57% 0.00
A3360 Issue of PO to Supplier 7.00 19-Aug-14 26-Aug-14 24-Feb-15 03-Mar-15 -46.00 100% 0% 0.00
A3370 Manufacturing /Procurement and Delivery of the Material 180.00 27-Aug-14 30-Mar-15 04-Mar-15 05-Oct-15 -46.00 16.67% 0% 0.00
ELV 227.00 19-Mar-14 28-Apr-15 16-Feb-14 A 03-Mar-15 151.00 0% 0% 0.00
BMS 227.00 28-Oct-14 28-Apr-15 08-Jun-14 A 03-Mar-15 151.00 0% 0% 0.00
A3420 Material Submittal 14.00 28-Oct-14 12-Nov-14 08-Jun-14 A 20-Aug-14 A 0% 100% 0.00
A3430 Material Approval 14.00 13-Nov-14 29-Nov-14 09-Jun-14 A 31-Aug-14 A 0% 100% 0.00
A3440 Issue of PO to Supplier 7.00 30-Nov-14 08-Dec-14 01-Oct-14 11-Oct-14 151.00 0% 0% 0.00
A3450 Manufacturing /Procurement and Delivery of the Material 120.00 09-Dec-14 28-Apr-15 12-Oct-14 03-Mar-15 151.00 0% 0% 0.00
FA System Panels 157.00 19-Mar-14 27-Oct-14 16-Feb-14 A 27-Oct-14 20.00 0% 0% 0.00
A3380 Material Submittal 14.00 19-Mar-14 03-Apr-14 16-Feb-14 A 20-May-14 A 100% 100% 0.00
A3390 Material Approval 14.00 05-Apr-14 20-Apr-14 17-Feb-14 A 04-Jun-14 A 100% 100% 0.00
A3400 Issue of PO to Supplier 7.00 21-Apr-14 28-Apr-14 05-Jun-14 A 23-Jun-14 A 100% 100% 0.00
A3410 Manufacturing /Procurement and Delivery of the Material 150.00 29-Apr-14 27-Oct-14 24-Jun-14 A 27-Oct-14 20.00 86.67% 0% 0.00
HVAC 284.00 26-Mar-14 22-Jul-15 02-Feb-14 A 19-Apr-15 96.00 0% 0% 0.00
FAHU 167.00 23-Apr-14 14-Dec-14 03-Mar-14 A 15-Dec-14 5.00 0% 0% 0.00
A3500 Material Submittal 14.00 23-Apr-14 08-May-14 03-Mar-14 A 20-May-14 A 100% 100% 0.00
A3510 Material Approval 14.00 10-May-14 25-May-14 04-Mar-14 A 10-Jun-14 A 100% 100% 0.00
A3520 Issue of PO to Supplier 7.00 26-May-14 03-Jun-14 11-Jun-14 A 22-Jun-14 A 100% 100% 0.00
A3530 Manufacturing /Procurement and Delivery of the Material 160.00 04-Jun-14 14-Dec-14 23-Jun-14 A 15-Dec-14 5.00 62.5% 61.88% 0.00
FCU 125.00 26-Mar-14 21-Aug-14 09-Feb-14 A 21-Aug-14 A 0% 0% 0.00
A3820 Material Submittal 14.00 26-Mar-14 10-Apr-14 09-Feb-14 A 03-Jul-14 A 100% 100% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 3 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
A3830 Material Approval 14.00 12-Apr-14 27-Apr-14 10-Feb-14 A 23-Jul-14 A 100% 100% 0.00
A3840 Issue of PO to Supplier 7.00 28-Apr-14 05-May-14 24-Jul-14 A 31-Jul-14 A 100% 100% 0.00
A3850 Manufacturing /Procurement and Delivery of the Material 90.00 06-May-14 21-Aug-14 01-Aug-14 A 21-Aug-14 A 100% 100% 0.00
Fans ( Pressurisation , Parking Extract Etc ) 195.00 29-May-14 19-Jan-15 10-Mar-14 A 09-Dec-14 34.00 0% 0% 0.00
A3460 Material Submittal 14.00 29-May-14 14-Jun-14 10-Mar-14 A 09-Jun-14 A 100% 100% 0.00
A3470 Material Approval 14.00 15-Jun-14 30-Jun-14 11-Mar-14 A 01-Jul-14 A 100% 100% 0.00
A3480 Issue of PO to Supplier 7.00 01-Jul-14 08-Jul-14 02-Jul-14 A 22-Jul-14 A 100% 100% 0.00
A3490 Manufacturing /Procurement and Delivery of the Material 160.00 09-Jul-14 19-Jan-15 23-Jul-14 A 09-Dec-14 34.00 43.75% 65% 0.00
Chilled Water Pumps 195.00 29-May-14 19-Jan-15 05-Mar-14 A 18-Mar-15 -50.00 0% 0% 0.00
A3540 Material Submittal 14.00 29-May-14 14-Jun-14 05-Mar-14 A 03-Jul-14 A 100% 100% 0.00
A3550 Material Approval 14.00 15-Jun-14 30-Jun-14 06-Mar-14 A 19-Jul-14 A 100% 100% 0.00
A3560 Issue of PO to Supplier 7.00 01-Jul-14 08-Jul-14 20-Jul-14 A 24-Aug-14 A 100% 100% 0.00
A3570 Manufacturing /Procurement and Delivery of the Material 160.00 09-Jul-14 19-Jan-15 25-Aug-14 A 18-Mar-15 -50.00 43.75% 12.5% 0.00
Cooling Tower 257.00 03-Dec-14 22-Jul-15 25-May-14 A 19-Apr-15 96.00 0% 0% 0.00
A3580 Material Submittal 14.00 03-Dec-14 18-Dec-14 25-May-14 A 12-Aug-14 A 0% 100% 0.00
A3590 Material Approval 14.00 20-Dec-14 05-Jan-15 26-May-14 A 13-Aug-14 A 0% 100% 0.00
A3600 Issue of PO to Supplier 7.00 06-Jan-15 13-Jan-15 01-Oct-14 11-Oct-14 96.00 0% 0% 0.00
A3610 Manufacturing /Procurement and Delivery of the Material 160.00 14-Jan-15 22-Jul-15 12-Oct-14 19-Apr-15 96.00 0% 0% 0.00
Chiller 215.00 22-May-14 05-Feb-15 08-Mar-14 A 15-Mar-15 4.00 0% 0% 0.00
A3620 Material Submittal 14.00 22-May-14 08-Jun-14 08-Mar-14 A 09-Jun-14 A 100% 100% 0.00
A3630 Material Approval 14.00 09-Jun-14 24-Jun-14 09-Mar-14 A 19-Jun-14 A 100% 100% 0.00
A3640 Issue of PO to Supplier 7.00 25-Jun-14 02-Jul-14 21-Jun-14 A 22-Jun-14 A 100% 100% 0.00
A3650 Manufacturing /Procurement and Delivery of the Material 180.00 03-Jul-14 05-Feb-15 24-Jun-14 A 15-Mar-15 4.00 41.67% 23.89% 0.00
Heat Exchanger 195.00 30-Apr-14 21-Dec-14 02-Feb-14 A 19-Nov-14 36.00 0% 0% 0.00
A3660 Material Submittal 14.00 30-Apr-14 15-May-14 02-Feb-14 A 13-May-14 A 100% 100% 0.00
A3670 Material Approval 14.00 17-May-14 02-Jun-14 03-Feb-14 A 01-Jun-14 A 100% 100% 0.00
A3680 Issue of PO to Supplier 7.00 03-Jun-14 10-Jun-14 02-Jun-14 A 22-Jul-14 A 100% 100% 0.00
A3690 Manufacturing /Procurement and Delivery of the Material 160.00 11-Jun-14 21-Dec-14 23-Jul-14 A 19-Nov-14 36.00 58.75% 75% 0.00
Fire Fighting 215.00 22-May-14 03-Jun-15 01-May-14 A 15-Jun-15 45.00 0% 0% 0.00
Fire Pumps 187.00 22-May-14 05-Feb-15 01-May-14 A 12-May-15 -43.00 0% 0% 0.00
A3700 Material Submittal 14.00 22-May-14 08-Jun-14 01-May-14 A 18-May-14 A 100% 100% 0.00
A3710 Material Approval 14.00 09-Jun-14 24-Jun-14 19-May-14 A 05-Jun-14 A 100% 100% 0.00
A3720 Issue of PO to Supplier 7.00 25-Jun-14 02-Jul-14 01-Oct-14 11-Oct-14 -43.00 100% 0% 0.00
A3730 Manufacturing /Procurement and Delivery of the Material 180.00 03-Jul-14 05-Feb-15 12-Oct-14 12-May-15 -43.00 41.67% 0% 0.00
FM200 215.00 20-Sep-14 03-Jun-15 01-Oct-14 15-Jun-15 45.00 0% 0% 0.00
A4020 Material Submittal 14.00 20-Sep-14 07-Oct-14 01-Oct-14 19-Oct-14 45.00 71.43% 0% 0.00
A4030 Material Approval 14.00 08-Oct-14 23-Oct-14 20-Oct-14 05-Nov-14 45.00 0% 0% 0.00
A4040 Issue of PO to Supplier 7.00 26-Oct-14 02-Nov-14 06-Nov-14 13-Nov-14 45.00 0% 0% 0.00
A4050 Manufacturing /Procurement and Delivery of the Material 180.00 03-Nov-14 03-Jun-15 15-Nov-14 15-Jun-15 45.00 0% 0% 0.00
Plumbing 319.00 14-Sep-14 18-Mar-15 14-Jan-14 A 03-Mar-15 96.00 0% 0% 0.00
Sump Pump 192.00 14-Sep-14 18-Mar-15 29-Jun-14 A 03-Mar-15 96.00 0% 0% 0.00
A3780 Material Submittal 14.00 14-Sep-14 29-Sep-14 29-Jun-14 A 04-Aug-14 A 100% 100% 0.00
A3790 Material Approval 14.00 30-Sep-14 18-Oct-14 30-Jun-14 A 14-Aug-14 A 7.14% 100% 0.00
A3800 Issue of PO to Supplier 7.00 19-Oct-14 27-Oct-14 01-Oct-14 11-Oct-14 96.00 0% 0% 0.00
A3810 Manufacturing /Procurement and Delivery of the Material 120.00 28-Oct-14 18-Mar-15 12-Oct-14 03-Mar-15 96.00 0% 0% 0.00
Water Heat er 155.00 14-Sep-14 18-Mar-15 14-Jan-14 A 31-May-14 A 0% 0% 0.00
A3860 Material Submittal 14.00 14-Sep-14 29-Sep-14 14-Jan-14 A 16-Apr-14 A 100% 100% 0.00
A3880 Issue of PO to Supplier 7.00 19-Oct-14 27-Oct-14 04-May-14 A 14-May-14 A 0% 100% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Issue of PO to Supplier
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 4 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
A3870 Material Approval 14.00 30-Sep-14 18-Oct-14 15-May-14 A 20-May-14 A 7.14% 100% 0.00
A3890 Manufacturing /Procurement and Delivery of the Material 120.00 28-Oct-14 18-Mar-15 21-May-14 A 31-May-14 A 0% 100% 0.00
Booster Pump 192.00 14-Sep-14 18-Mar-15 03-Jun-14 A 03-Mar-15 96.00 0% 0% 0.00
A3900 Material Submittal 14.00 14-Sep-14 29-Sep-14 03-Jun-14 A 29-Jun-14 A 100% 100% 0.00
A3910 Material Approval 14.00 30-Sep-14 18-Oct-14 04-Jun-14 A 08-Jul-14 A 7.14% 100% 0.00
A3920 Issue of PO to Supplier 7.00 19-Oct-14 27-Oct-14 01-Oct-14 11-Oct-14 96.00 0% 0% 0.00
A3930 Manufacturing /Procurement and Delivery of the Material 120.00 28-Oct-14 18-Mar-15 12-Oct-14 03-Mar-15 96.00 0% 0% 0.00
Transfer Pump 192.00 14-Sep-14 18-Mar-15 03-Jun-14 A 03-Mar-15 96.00 0% 0% 0.00
A3940 Material Submittal 14.00 14-Sep-14 29-Sep-14 03-Jun-14 A 29-Jun-14 A 100% 100% 0.00
A3950 Material Approval 14.00 30-Sep-14 18-Oct-14 04-Jun-14 A 08-Jul-14 A 7.14% 100% 0.00
A3960 Issue of PO to Supplier 7.00 19-Oct-14 27-Oct-14 01-Oct-14 11-Oct-14 96.00 0% 0% 0.00
A3970 Manufacturing /Procurement and Delivery of the Material 120.00 28-Oct-14 18-Mar-15 12-Oct-14 03-Mar-15 96.00 0% 0% 0.00
Sewage Pump 192.00 14-Sep-14 18-Mar-15 29-Jun-14 A 03-Mar-15 96.00 0% 0% 0.00
A3980 Material Submittal 14.00 14-Sep-14 29-Sep-14 29-Jun-14 A 04-Aug-14 A 100% 100% 0.00
A3990 Material Approval 14.00 30-Sep-14 18-Oct-14 30-Jun-14 A 14-Aug-14 A 7.14% 100% 0.00
A4000 Issue of PO to Supplier 7.00 19-Oct-14 27-Oct-14 01-Oct-14 11-Oct-14 96.00 0% 0% 0.00
A4010 Manufacturing /Procurement and Delivery of the Material 120.00 28-Oct-14 18-Mar-15 12-Oct-14 03-Mar-15 96.00 0% 0% 0.00
DOMESTIC SUBCONTRACTORS 1589.00 24-Feb-14 22-Mar-15 19-Jun-11 A 24-Oct-15 186.00 0% 0% 0.00
Prime Cost 363.00 01-Apr-14 28-Sep-15 24-Feb-14 A 28-Sep-15 65.00 0% 0% 0.00
SUB-STRUCTURE 938.00 24-Feb-14 24-Feb-14 22-Jun-11 A 20-Sep-13 A 0% 0% 0.00
SUPER STRUCTURE 1633.00 24-Feb-14 13-Jul-15 11-Apr-13 A 02-Feb-16 A 0% 0% 0.00
MEP 1835.00 24-Feb-14 07-Dec-15 24-Feb-14 A 24-Feb-14 A 0% 0% 0.00
CONSTRUCTION 1603.00 24-Feb-14 30-Apr-16 26-Jun-11 A 27-Aug-16 -88.00 25.09% 22.48% 0.90
STRUCTURAL , ARCHITECTURAL , MEP 1530.00 24-Feb-14 30-Apr-16 26-Jun-11 A 31-May-16 -15.00 29.36% 28.06% 0.96
FOUNDATION WORKS 1363.00 24-Feb-14 11-Oct-15 26-Jun-11 A 16-Nov-15 -4.00 75.13% 71.94% 0.96
BASEMENT & PODIUM 1455.00 24-Feb-14 30-Apr-16 31-May-13 A 23-May-16 -8.00 48.62% 48.59% 1.00
TOWER 696.00 24-Feb-14 06-Apr-16 10-Feb-14 A 31-May-16 -45.00 24.04% 22.56% 0.94
LEVELS 06 - 29 577.00 24-Feb-14 14-Nov-15 10-Feb-14 A 12-Jan-16 -50.00 68.5% 64.97% 0.95
LEVEL 06 468.00 24-Feb-14 21-May-15 10-Feb-14 A 02-Sep-15 -72.00 76.72% 72.35% 0.94
STRUCTURAL - LEVEL 6 20.00 24-Feb-14 16-Mar-14 10-Feb-14 A 09-Mar-14 A 100% 100% 1.00
DHCWA07100 Core Wal - Level 06 6.00 24-Feb-14 24-Feb-14 15-Feb-14 A 20-Feb-14 A 100% 100% 1.00
DHSLA06100 Construction of Horizontals - L06 4.00 10-Mar-14 11-Mar-14 10-Feb-14 A 04-Mar-14 A 100% 100% 1.00
DHCWA07110 Construction of Verticals - L06 3.00 13-Mar-14 16-Mar-14 06-Mar-14 A 09-Mar-14 A 100% 100% 1.00
STAIRCASES 4.00 25-May-14 29-May-14 08-May-14 A 18-May-14 A 0% 0% 0.00
DHSLA06102 Stair # 2 4.00 25-May-14 29-May-14 08-May-14 A 13-May-14 A 100% 100% 0.00
DHSLA06104 Stair # 1 4.00 25-May-14 29-May-14 13-May-14 A 18-May-14 A 100% 100% 0.00
FINISHES - LEVEL 06 246.00 12-Apr-14 21-May-15 24-Feb-14 A 14-Jul-15 -31.00 40.01% 18.14% 0.45
Dry area 230.00 06-May-14 02-May-15 28-Apr-14 A 25-Jun-15 -43.00 30.8% 15.86% 0.51
DHFSH06100 Block Work in Dry Area 6.00 06-May-14 12-May-14 28-Apr-14 A 19-May-14 A 100% 100% 1.00
DHFSH06120 Marking,Cutting & Chasing - Dry Area 4.00 13-May-14 17-May-14 15-May-14 A 03-Jun-14 A 100% 100% 1.00
DHFSH06130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 08-Jun-14 12-Jun-14 21-May-14 A 07-Jun-14 A 100% 100% 1.00
DHFSH06160 Plaster in Dry Area 8.00 12-Jun-14 22-Jun-14 25-May-14 A 18-Jun-14 A 100% 100% 1.00
DHFSH06190 Dry Area Floor Screed 7.00 22-Jun-14 30-Jun-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00
DHFSH06230 Dry Area Painting - Primer 4.00 30-Jun-14 05-Jul-14 01-Sep-14 A 01-Oct-14 -8.00 100% 80% 0.00
DHFSH06260 Dry Area Painting - Stucco 6.00 05-Jul-14 12-Jul-14 06-Sep-14 A 06-Oct-14 48.00 100% 60% 0.00
DHFSH06290 Dry Area False Ceiling Suspension 6.00 23-Aug-14 30-Aug-14 02-Sep-14 A 09-Oct-14 -8.00 100% 15% 0.15
DHFSH06350 Dry Area False Ceiling Tiling / Boarding 5.00 17-Sep-14 23-Sep-14 14-Oct-14 19-Oct-14 37.00 100% 0% 0.00
DHFSH06400 Dry Area Painting - 1st Coat 5.00 23-Sep-14 29-Sep-14 20-Oct-14 26-Oct-14 37.00 100% 0% 0.00
DHFSH06450 Dry Area Flooring 5.00 12-Oct-14 18-Oct-14 02-Nov-14 06-Nov-14 32.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Material Approval
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Material Submittal
Material Approval
Issue of PO to Supplier
Manufacturing /Procurement and Delivery of the Material
Construction of Horizontals - L06
Construction of Verticals - L06
Stair # 2
Stair # 1
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 5 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH06430 Installation of Timber Doors & Ironmongery 5.00 22-Mar-15 26-Mar-15 20-May-15 25-May-15 -50.00 0% 0% 0.00
DHFSH06802 Installation of Wardrobe 12.00 22-Mar-15 04-Apr-15 20-May-15 02-Jun-15 -50.00 0% 0% 0.00
DHFSH06500 Paint Final Coat 6.00 26-Apr-15 02-May-15 20-Jun-15 25-Jun-15 -43.00 0% 0% 0.00
Wet area 204.00 13-May-14 04-Apr-15 24-Feb-14 A 02-Jun-15 -45.00 43.27% 24.17% 0.56
DHFSH06220 Wet Area Floor Screed 4.00 29-Sep-14 06-Oct-14 24-Feb-14 A 24-Feb-14 A 28.13% 100% 0.00
DHFSH06110 Block Work in Wet Area 6.00 13-May-14 19-May-14 28-Apr-14 A 19-May-14 A 100% 100% 0.00
DHFSH06140 Marking,Cutting & Chasing - Wet Area 4.00 20-May-14 24-May-14 15-May-14 A 03-Jun-14 A 100% 100% 1.00
DHFSH06150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 08-Jun-14 12-Jun-14 21-May-14 A 07-Jun-14 A 100% 100% 1.00
DHFSH06170 Plaster in Wet Area 4.00 12-Jun-14 17-Jun-14 25-May-14 A 18-Jun-14 A 100% 100% 1.00
DHFSH06180 Wet Area Wall Tiling 6.00 23-Aug-14 30-Aug-14 02-Sep-14 A 02-Oct-14 -23.00 100% 60% 0.60
DHFSH06300 Wet Area False Ceiling Suspension 5.00 01-Sep-14 07-Sep-14 11-Oct-14 15-Oct-14 7.00 100% 0% 0.00
DHFSH06370 Wet Area False Ceiling Tiling/Boarding 6.00 17-Sep-14 24-Sep-14 14-Oct-14 20-Oct-14 15.00 100% 0% 0.00
DHFSH06210 Wet Area Waterproofing 4.00 24-Sep-14 29-Sep-14 16-Sep-14 A 26-Oct-14 15.00 100% 10% 0.10
DHFSH06250 Wet Area Floor Tiling 5.00 06-Oct-14 12-Oct-14 27-Oct-14 01-Nov-14 15.00 0% 0% 0.00
DHFSH06460 Cabinet Carcass 5.00 18-Oct-14 22-Oct-14 02-Nov-14 06-Nov-14 15.00 0% 0% 0.00
DHFSH06420 Installation of Shower Enclosure 4.00 28-Mar-15 31-Mar-15 26-May-15 30-May-15 -42.00 0% 0% 0.00
DHFSH06390 Installation of Vanity Counters & Tops 5.00 28-Mar-15 01-Apr-15 26-May-15 31-May-15 -50.00 0% 0% 0.00
DHFSH06800 Installation of Kitchen Cabinet 12.00 22-Mar-15 04-Apr-15 20-May-15 02-Jun-15 -50.00 0% 0% 0.00
Corridor/ Lift Lobby 44.00 30-Jun-14 10-Mar-15 01-Sep-14 A 24-Nov-14 89.00 66.67% 0% 0.00
DHFSH06240 Corridor/Lift Lobby Floor Screed 4.00 30-Jun-14 05-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00
DHFSH06270 Lift Lobby Painting - Primer & Stucco 6.00 05-Jul-14 12-Jul-14 01-Sep-14 A 02-Oct-14 13.00 100% 75% 0.00
DHFSH06310 Lift Lobby False Ceiling Suspension 6.00 03-Sep-14 10-Sep-14 13-Oct-14 19-Oct-14 7.00 100% 0% 0.00
DHFSH06360 Lift Lobby False Ceiling Tiling / Boarding 5.00 17-Sep-14 23-Sep-14 20-Oct-14 26-Oct-14 93.00 100% 0% 0.00
DHFSH06410 Lift Lobby Painting - 1st Coat 6.00 23-Sep-14 30-Sep-14 27-Oct-14 02-Nov-14 93.00 100% 0% 0.00
DHFSH06470 Lift Lobby Flooring 6.00 18-Oct-14 26-Oct-14 08-Nov-14 13-Nov-14 89.00 0% 0% 0.00
DHFSH06490 Utility Rooms- Epoxy Flooring 6.00 26-Oct-14 02-Nov-14 15-Nov-14 20-Nov-14 89.00 0% 0% 0.00
DHFSH06440 Installation of Steel Doors & Windows 3.00 08-Mar-15 10-Mar-15 22-Nov-14 24-Nov-14 89.00 0% 0% 0.00
Staircase 51.00 22-Jun-14 18-Mar-15 01-Oct-14 03-Dec-14 91.00 45.08% 0% 0.00
DHFSH06200 Staircase Plastering 4.00 22-Jun-14 26-Jun-14 01-Oct-14 07-Oct-14 27.00 100% 0% 0.00
DHFSH06280 Staircase Painting - Primer & Stucco 6.00 12-Jul-14 19-Jul-14 08-Oct-14 14-Oct-14 119.00 100% 0% 0.00
DHFSH06320 Staircase Handrail Fixing 3.00 04-Dec-14 08-Dec-14 15-Oct-14 18-Oct-14 119.00 0% 0% 0.00
DHFSH06330 Staircase Painting 1st Coat 3.00 08-Dec-14 11-Dec-14 27-Oct-14 29-Oct-14 113.00 0% 0% 0.00
DHFSH06340 Staircase Final Painting 5.00 11-Mar-15 16-Mar-15 25-Nov-14 30-Nov-14 91.00 0% 0% 0.00
DHFSH06380 Staircase Epoxy Flooring 2.00 17-Mar-15 18-Mar-15 01-Dec-14 03-Dec-14 91.00 0% 0% 0.00
General 246.00 12-Apr-14 21-May-15 03-Apr-14 A 14-Jul-15 -43.00 0% 0% 0.00
DHSTR06000 Access from Structure 0.00 12-Apr-14 03-Apr-14 A 100% 100% 0.00
DHFSH06510 Snagging & De-Snagging 16.00 03-May-15 21-May-15 27-Jun-15 14-Jul-15 -43.00 0% 0% 0.00
Show Flats 1 & 2 116.00 12-Jul-14 29-Nov-14 01-Oct-14 18-Feb-15 93.00 0% 0% 0.00
DHFSH06511 Finishes & MEP Works - Flat 1 (Workmanship) 116.00 12-Jul-14 29-Nov-14 01-Oct-14 18-Feb-15 93.00 58.62% 0% 0.00
DHFSH06512 Finishes & MEP Works - Flat 2 (Workmanship) 116.00 12-Jul-14 29-Nov-14 01-Oct-14 18-Feb-15 93.00 58.62% 0% 0.00
MEP - LEVEL 06 465.00 08-Mar-14 25-Apr-15 10-Feb-14 A 02-Sep-15 -106.00 70.98% 70.98% 1.00
DHMEP06000 Embeded Conduits & Boxex - Concrete Works 4.00 08-Mar-14 11-Mar-14 10-Feb-14 A 04-Mar-14 A 100% 100% 0.00
DHMEP06100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C15a-bAlipnrg-1 ,4 Wiring et0c5-May-14 03-Apr-14 A 29-Apr-14 A 100% 100% 1.00
DHMEP06130 Cable Trays & Cable Trunking 6.00 13-May-14 19-May-14 03-Apr-14 A 29-Apr-14 A 100% 100% 0.00
DHMEP06160 Pressure Testing of Pipes 12.00 23-Aug-14 04-Sep-14 28-Apr-14 A 17-May-14 A 100% 100% 0.00
DHMEP06120 Embeded Condiuts,Boxes ,Sleeves and Pix Pipes in Walls 6.00 25-May-14 01-Jun-14 20-May-14 A 05-Jun-14 A 100% 100% 1.00
DHMEP06110 MEP Works in Risers& Clearance 5.00 12-Jul-14 16-Jul-14 05-Apr-14 A 01-Oct-14 -33.00 100% 78% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Wet Area Floor Screed
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Installation of Steel Doors & Windows
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Finishes & MEP Works - Flat 1 (Workmanship)
Finishes & MEP Works - Flat 2 (Workmanship)
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Pressure Testing of Pipes
Embeded Condiuts,Boxes ,Sleeves and Pix Pipes in Walls
MEP Works in Risers& Clearance
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 6 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHMEP06140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es10-Sep-14 17-Sep-14 01-Jun-14 A 13-Oct-14 15.00 100% 71% 0.00
DHMEP06150 MEP Final Fixes 6.00 06-Apr-15 12-Apr-15 01-Jun-15 07-Jun-15 -43.00 0% 0% 0.00
DHMEP06170 Sanitary ware /Toilet accessories 6.00 11-Apr-15 16-Apr-15 04-Jun-15 10-Jun-15 -43.00 0% 0% 0.00
DHMEP06200 Pre-Testing & Commissioning 7.00 18-Apr-15 25-Apr-15 11-Jun-15 18-Jun-15 -43.00 0% 0% 0.00
DHMEP06690 Busbar - L6 to L10 20.00 17-Feb-15 11-Mar-15 11-Aug-15 02-Sep-15 -144.00 0% 0% 0.00
LEVEL 07 433.00 24-Feb-14 04-Jun-15 20-Feb-14 A 30-Jul-15 -43.00 77.04% 72.04% 0.94
STRUCTURAL - LEVEL 07 21.00 24-Feb-14 24-Mar-14 20-Feb-14 A 20-Mar-14 A 100% 100% 1.00
DHCWA08100 Core Wal - Level 07 9.00 24-Feb-14 05-Mar-14 20-Feb-14 A 28-Feb-14 A 100% 100% 1.00
DHSLA07100 Construction of Horizontals - L07 4.00 17-Mar-14 20-Mar-14 06-Mar-14 A 16-Mar-14 A 100% 100% 1.00
DHCWA08110 Construction of Verticals - L07 3.00 22-Mar-14 24-Mar-14 16-Mar-14 A 20-Mar-14 A 100% 100% 1.00
STAIRCASES 4.00 02-Jun-14 05-Jun-14 17-May-14 A 24-May-14 A 0% 0% 0.00
A1330 Stair # 2 4.00 02-Jun-14 05-Jun-14 17-May-14 A 22-May-14 A 100% 100% 0.00
A1320 Stair # 1 4.00 02-Jun-14 05-Jun-14 18-May-14 A 24-May-14 A 100% 100% 0.00
FINISHES - LEVEL 07 258.00 19-Apr-14 04-Jun-15 14-Apr-14 A 30-Jul-15 -43.00 45.11% 22.06% 0.49
Dry area 232.00 12-May-14 09-May-15 03-May-14 A 02-Jul-15 -33.00 45.17% 35.49% 0.79
DHFSH07100 Block Work in Dry Area 6.00 12-May-14 18-May-14 03-May-14 A 24-May-14 A 100% 100% 1.00
DHFSH07120 Marking,Cutting & Chasing - Dry Area 4.00 19-May-14 22-May-14 25-May-14 A 10-Jun-14 A 100% 100% 1.00
DHFSH07130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 24-May-14 28-May-14 16-Jun-14 A 22-Jun-14 A 100% 100% 1.00
DHFSH07160 Plaster in Dry Area 8.00 19-Jun-14 29-Jun-14 18-Jun-14 A 24-Jun-14 A 100% 100% 1.00
DHFSH07190 Dry Area Floor Screed 7.00 29-Jun-14 07-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00
DHFSH07230 Dry Area Painting - Primer 4.00 07-Jul-14 12-Jul-14 04-Sep-14 A 01-Oct-14 -1.00 100% 80% 0.00
DHFSH07260 Dry Area Painting - Stucco 6.00 12-Jul-14 19-Jul-14 09-Sep-14 A 06-Oct-14 53.00 100% 60% 0.00
DHFSH07290 Dry Area False Ceiling Suspension 6.00 27-Aug-14 03-Sep-14 08-Oct-14 14-Oct-14 -8.00 100% 0% 0.00
DHFSH07350 Dry Area False Ceiling Tiling / Boarding 5.00 21-Sep-14 27-Sep-14 02-Nov-14 06-Nov-14 27.00 100% 0% 0.00
DHFSH07400 Dry Area Painting - 1st Coat 5.00 27-Sep-14 02-Oct-14 08-Nov-14 12-Nov-14 27.00 62.5% 0% 0.00
DHFSH07450 Dry Area Flooring 5.00 18-Oct-14 23-Oct-14 22-Nov-14 26-Nov-14 20.00 0% 0% 0.00
DHFSH07430 Installation of Timber Doors & Ironmongery 5.00 28-Mar-15 01-Apr-15 26-May-15 31-May-15 -50.00 0% 0% 0.00
DHFSH07802 Installation of Wardrobe 12.00 05-Apr-15 18-Apr-15 03-Jun-15 16-Jun-15 -50.00 0% 0% 0.00
DHFSH07500 Paint Final Coat 6.00 03-May-15 09-May-15 27-Jun-15 02-Jul-15 -33.00 0% 0% 0.00
Wet area 218.00 12-May-14 18-Apr-15 03-May-14 A 16-Jun-15 -50.00 43.27% 15.42% 0.36
DHFSH07110 Block Work in Wet Area 6.00 12-May-14 18-May-14 03-May-14 A 24-May-14 A 100% 100% 0.00
DHFSH07140 Marking,Cutting & Chasing - Wet Area 4.00 19-May-14 22-May-14 25-May-14 A 10-Jun-14 A 100% 100% 1.00
DHFSH07150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 24-May-14 28-May-14 16-Jun-14 A 22-Jun-14 A 100% 100% 1.00
DHFSH07170 Plaster in Wet Area 4.00 16-Jun-14 21-Jun-14 18-Jun-14 A 24-Jun-14 A 100% 100% 1.00
DHFSH07180 Wet Area Wall Tiling 6.00 27-Aug-14 03-Sep-14 09-Sep-14 A 09-Oct-14 1.00 100% 20% 0.20
DHFSH07300 Wet Area False Ceiling Suspension 5.00 03-Sep-14 09-Sep-14 15-Oct-14 20-Oct-14 3.00 100% 0% 0.00
DHFSH07370 Wet Area False Ceiling Tiling/Boarding 4.00 21-Sep-14 25-Sep-14 02-Nov-14 05-Nov-14 3.00 100% 0% 0.00
DHFSH07210 Wet Area Waterproofing 4.00 25-Sep-14 30-Sep-14 22-Sep-14 A 10-Nov-14 3.00 100% 10% 0.10
DHFSH07220 Wet Area Floor Screed 4.00 30-Sep-14 07-Oct-14 11-Nov-14 15-Nov-14 3.00 3.13% 0% 0.00
DHFSH07250 Wet Area Floor Tiling 5.00 07-Oct-14 13-Oct-14 16-Nov-14 20-Nov-14 3.00 0% 0% 0.00
DHFSH06480 Cabinet Carcass 5.00 23-Oct-14 29-Oct-14 22-Nov-14 26-Nov-14 3.00 0% 0% 0.00
DHFSH07420 Installation of Shower Enclosure 4.00 02-Apr-15 06-Apr-15 01-Jun-15 04-Jun-15 -41.00 0% 0% 0.00
DHFSH07390 Installation of Vanity Counters & Tops 5.00 02-Apr-15 07-Apr-15 01-Jun-15 06-Jun-15 -50.00 0% 0% 0.00
DHFSH07800 Installation of Kitchen Cabinet 12.00 05-Apr-15 18-Apr-15 03-Jun-15 16-Jun-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 58.00 07-Jul-14 14-Mar-15 01-Sep-14 A 11-Dec-14 123.00 66.67% 0% 0.00
DHFSH07240 Corridor/Lift Lobby Floor Screed 4.00 07-Jul-14 12-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00
DHFSH07270 Lift Lobby Painting - Primer & Stucco 6.00 12-Jul-14 19-Jul-14 04-Sep-14 A 02-Oct-14 16.00 100% 75% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Busbar - L6 to L10
Construction of Horizontals - L07
Construction of Verticals - L07
Stair # 2
Stair # 1
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 7 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH07310 Lift Lobby False Ceiling Suspension 6.00 09-Sep-14 16-Sep-14 21-Oct-14 28-Oct-14 3.00 100% 0% 0.00
DHFSH07360 Lift Lobby False Ceiling Tiling / Boarding 5.00 21-Sep-14 27-Sep-14 02-Nov-14 06-Nov-14 112.00 100% 0% 0.00
DHFSH07410 Lift Lobby Painting - 1st Coat 6.00 27-Sep-14 06-Oct-14 08-Nov-14 13-Nov-14 112.00 52.08% 0% 0.00
DHFSH07440 Installation of Steel Doors & Windows 3.00 11-Mar-15 14-Mar-15 25-Nov-14 27-Nov-14 89.00 0% 0% 0.00
DHFSH07470 Lift Lobby Flooring 6.00 23-Oct-14 01-Nov-14 27-Nov-14 04-Dec-14 123.00 0% 0% 0.00
DHFSH07490 Utility Rooms- Epoxy Flooring 6.00 01-Nov-14 08-Nov-14 06-Dec-14 11-Dec-14 123.00 0% 0% 0.00
Staircase 54.00 29-Jun-14 22-Mar-15 01-Oct-14 07-Dec-14 96.00 45.08% 0% 0.00
DHFSH07200 Staircase Plastering 4.00 29-Jun-14 03-Jul-14 01-Oct-14 07-Oct-14 124.00 100% 0% 0.00
DHFSH07280 Staircase Painting - Primer & Stucco 6.00 19-Jul-14 26-Jul-14 08-Oct-14 14-Oct-14 124.00 100% 0% 0.00
DHFSH07320 Staircase Handrail Fixing 3.00 08-Dec-14 11-Dec-14 19-Oct-14 21-Oct-14 123.00 0% 0% 0.00
DHFSH07330 Staircase Painting 1st Coat 3.00 11-Dec-14 15-Dec-14 13-Nov-14 16-Nov-14 105.00 0% 0% 0.00
DHFSH07340 Staircase Final Painting 5.00 15-Mar-15 19-Mar-15 29-Nov-14 04-Dec-14 96.00 0% 0% 0.00
DHFSH07380 Staircase Epoxy Flooring 2.00 21-Mar-15 22-Mar-15 06-Dec-14 07-Dec-14 96.00 0% 0% 0.00
General 258.00 19-Apr-14 04-Jun-15 14-Apr-14 A 30-Jul-15 -43.00 0% 0% 0.00
DHSTR07000 Access from Structure 0.00 19-Apr-14 14-Apr-14 A 100% 100% 0.00
DHFSH07510 Snagging & De-Snagging 12.00 23-May-15 04-Jun-15 15-Jul-15 30-Jul-15 -43.00 0% 0% 0.00
MEP - LEVEL 07 398.00 17-Mar-14 02-May-15 06-Mar-14 A 25-Jun-15 -43.00 70.98% 70.98% 1.00
DHMEP07000 Embeded Conduits & Boxex - Concrete Works 4.00 17-Mar-14 20-Mar-14 06-Mar-14 A 16-Mar-14 A 100% 100% 0.00
DHMEP07100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C21a-bAlipnrg-1 ,4 Wiring et1c1-May-14 14-Apr-14 A 28-May-14 A 100% 100% 1.00
DHMEP07130 Cable Trays & Cable Trunking 6.00 19-May-14 25-May-14 14-Apr-14 A 28-May-14 A 100% 100% 0.00
DHMEP07120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 24-May-14 31-May-14 01-Jun-14 A 12-Jun-14 A 100% 100% 1.00
DHMEP07160 Pressure Testing of Pipes 12.00 01-Jun-14 14-Jun-14 07-May-14 A 10-Jul-14 A 100% 100% 0.00
DHMEP07110 MEP Works in Risers& Clearance 5.00 17-Jul-14 22-Jul-14 17-Apr-14 A 02-Oct-14 -33.00 100% 78% 0.00
DHMEP07140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es14-Sep-14 21-Sep-14 01-Jul-14 A 01-Nov-14 3.00 100% 71% 0.00
DHMEP07150 MEP Final Fixes 6.00 11-Apr-15 16-Apr-15 07-Jun-15 13-Jun-15 -42.00 0% 0% 0.00
DHMEP06180 Sanitary ware /Toilet accessories 6.00 14-Apr-15 20-Apr-15 10-Jun-15 16-Jun-15 -42.00 0% 0% 0.00
DHMEP07200 Pre-Testing & Commissioning 7.00 25-Apr-15 02-May-15 18-Jun-15 25-Jun-15 -43.00 0% 0% 0.00
LEVEL 08 434.00 06-Mar-14 11-Jun-15 01-Mar-14 A 06-Aug-15 -43.00 76.28% 70.79% 0.93
STRUCTURAL WORKS - LEVEL 08 22.00 06-Mar-14 31-Mar-14 01-Mar-14 A 28-Mar-14 A 100% 100% 1.00
DHCWA09100 Core Wal - Level 08 9.00 06-Mar-14 16-Mar-14 01-Mar-14 A 11-Mar-14 A 100% 100% 1.00
DHSLA08100 Construction of Horizontals - L08 4.00 24-Mar-14 27-Mar-14 16-Mar-14 A 24-Mar-14 A 100% 100% 1.00
DHCWA09110 Construction of Verticals - L08 3.00 29-Mar-14 31-Mar-14 25-Mar-14 A 28-Mar-14 A 100% 100% 1.00
STAIRCASES 4.00 08-Jun-14 11-Jun-14 22-May-14 A 31-May-14 A 0% 0% 0.00
A1350 Stair # 2 4.00 08-Jun-14 11-Jun-14 22-May-14 A 28-May-14 A 100% 100% 0.00
A1340 Stair # 1 4.00 08-Jun-14 11-Jun-14 25-May-14 A 31-May-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 08 280.00 26-Apr-14 11-Jun-15 19-Apr-14 A 06-Aug-15 -43.00 41.91% 20.02% 0.48
Dry area 236.00 19-May-14 17-May-15 11-May-14 A 09-Jul-15 -33.00 41.79% 35.49% 0.85
DHFSH08100 Block Work in Dry Area 6.00 19-May-14 25-May-14 11-May-14 A 31-May-14 A 100% 100% 1.00
DHFSH08120 Marking,Cutting & Chasing - Dry Area 4.00 26-May-14 31-May-14 28-May-14 A 12-Jun-14 A 100% 100% 1.00
DHFSH08130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 01-Jun-14 04-Jun-14 29-Jun-14 A 09-Jul-14 A 100% 100% 1.00
DHFSH08160 Plaster in Dry Area 8.00 24-Jun-14 03-Jul-14 06-Jul-14 A 28-Aug-14 A 100% 100% 1.00
DHFSH08190 Dry Area Floor Screed 7.00 03-Jul-14 12-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00
DHFSH08230 Dry Area Painting - Primer 4.00 12-Jul-14 16-Jul-14 06-Sep-14 A 01-Oct-14 -5.00 100% 0% 0.00
DHFSH08260 Dry Area Painting - Stucco 6.00 16-Jul-14 23-Jul-14 10-Sep-14 A 06-Oct-14 58.00 100% 0% 0.00
DHFSH08290 Dry Area False Ceiling Suspension 6.00 01-Sep-14 08-Sep-14 13-Oct-14 19-Oct-14 -8.00 100% 0% 0.00
DHFSH08350 Dry Area False Ceiling Tiling / Boarding 5.00 24-Sep-14 30-Sep-14 05-Nov-14 10-Nov-14 29.00 100% 0% 0.00
DHFSH08400 Dry Area Painting - 1st Coat 5.00 30-Sep-14 08-Oct-14 11-Nov-14 16-Nov-14 29.00 2.5% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Construction of Horizontals - L08
Construction of Verticals - L08
Stair # 2
Stair # 1
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 8 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH08450 Dry Area Flooring 5.00 23-Oct-14 30-Oct-14 27-Nov-14 03-Dec-14 20.00 0% 0% 0.00
DHFSH08430 Installation of Timber Doors & Ironmongery 5.00 02-Apr-15 07-Apr-15 01-Jun-15 06-Jun-15 -50.00 0% 0% 0.00
DHFSH08802 Installation of Wardrobe 12.00 19-Apr-15 02-May-15 17-Jun-15 30-Jun-15 -50.00 0% 0% 0.00
DHFSH08500 Paint Final Coat 6.00 10-May-15 17-May-15 04-Jul-15 09-Jul-15 -33.00 0% 0% 0.00
Wet area 224.00 19-May-14 02-May-15 11-May-14 A 30-Jun-15 -50.00 39.44% 11.04% 0.28
DHFSH08110 Block Work in Wet Area 6.00 19-May-14 25-May-14 11-May-14 A 31-May-14 A 100% 100% 0.00
DHFSH08140 Marking,Cutting & Chasing - Wet Area 4.00 26-May-14 31-May-14 28-May-14 A 12-Jun-14 A 100% 100% 1.00
DHFSH08150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 01-Jun-14 04-Jun-14 29-Jun-14 A 09-Jul-14 A 100% 100% 1.00
DHFSH08170 Plaster in Wet Area 4.00 19-Jun-14 24-Jun-14 06-Jul-14 A 28-Aug-14 A 100% 100% 1.00
DHFSH08180 Wet Area Wall Tiling 6.00 01-Sep-14 08-Sep-14 08-Oct-14 14-Oct-14 1.00 100% 0% 0.00
DHFSH08300 Wet Area False Ceiling Suspension 5.00 07-Sep-14 13-Sep-14 19-Oct-14 23-Oct-14 5.00 100% 0% 0.00
DHFSH08370 Wet Area False Ceiling Tiling/Boarding 4.00 24-Sep-14 29-Sep-14 05-Nov-14 09-Nov-14 5.00 100% 0% 0.00
DHFSH08210 Wet Area Waterproofing 4.00 29-Sep-14 06-Oct-14 28-Sep-14 A 13-Nov-14 5.00 28.13% 10% 0.36
DHFSH08220 Wet Area Floor Screed 4.00 06-Oct-14 11-Oct-14 15-Nov-14 18-Nov-14 5.00 0% 0% 0.00
DHFSH08250 Wet Area Floor Tiling 5.00 11-Oct-14 16-Oct-14 19-Nov-14 24-Nov-14 5.00 0% 0% 0.00
DHFSH06520 Cabinet Carcass 5.00 30-Oct-14 04-Nov-14 27-Nov-14 03-Dec-14 3.00 0% 0% 0.00
DHFSH08420 Installation of Shower Enclosure 4.00 08-Apr-15 12-Apr-15 07-Jun-15 10-Jun-15 -40.00 0% 0% 0.00
DHFSH08390 Installation of Vanity Counters & Tops 5.00 08-Apr-15 13-Apr-15 07-Jun-15 11-Jun-15 -50.00 0% 0% 0.00
DHFSH08800 Installation of Kitchen Cabinet 12.00 19-Apr-15 02-May-15 17-Jun-15 30-Jun-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 85.00 12-Jul-14 17-Mar-15 01-Sep-14 A 17-Dec-14 121.00 66.67% 0% 0.00
DHFSH08240 Corridor/Lift Lobby Floor Screed 4.00 12-Jul-14 16-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00
DHFSH08270 Lift Lobby Painting - Primer & Stucco 6.00 16-Jul-14 23-Jul-14 06-Sep-14 A 02-Oct-14 21.00 100% 0% 0.00
DHFSH08310 Lift Lobby False Ceiling Suspension 6.00 13-Sep-14 20-Sep-14 26-Oct-14 01-Nov-14 5.00 100% 0% 0.00
DHFSH08360 Lift Lobby False Ceiling Tiling / Boarding 5.00 24-Sep-14 30-Sep-14 05-Nov-14 10-Nov-14 112.00 100% 0% 0.00
DHFSH08410 Lift Lobby Painting - 1st Coat 6.00 30-Sep-14 09-Oct-14 11-Nov-14 17-Nov-14 112.00 2.08% 0% 0.00
DHFSH08440 Installation of Steel Doors & Windows 3.00 15-Mar-15 17-Mar-15 04-Dec-14 07-Dec-14 85.00 0% 0% 0.00
DHFSH08470 Lift Lobby Flooring 6.00 30-Oct-14 06-Nov-14 04-Dec-14 10-Dec-14 121.00 0% 0% 0.00
DHFSH08490 Utility Rooms- Epoxy Flooring 6.00 06-Nov-14 13-Nov-14 11-Dec-14 17-Dec-14 121.00 0% 0% 0.00
Staircase 61.00 03-Jul-14 25-Mar-15 01-Oct-14 15-Dec-14 91.00 45.08% 0% 0.00
DHFSH08200 Staircase Plastering 4.00 03-Jul-14 08-Jul-14 01-Oct-14 07-Oct-14 127.00 100% 0% 0.00
DHFSH08280 Staircase Painting - Primer & Stucco 6.00 23-Jul-14 02-Aug-14 08-Oct-14 14-Oct-14 127.00 100% 0% 0.00
DHFSH08320 Staircase Handrail Fixing 3.00 11-Dec-14 15-Dec-14 22-Oct-14 26-Oct-14 123.00 0% 0% 0.00
DHFSH08330 Staircase Painting 1st Coat 3.00 15-Dec-14 18-Dec-14 17-Nov-14 19-Nov-14 105.00 0% 0% 0.00
DHFSH08340 Staircase Final Painting 5.00 18-Mar-15 23-Mar-15 08-Dec-14 13-Dec-14 91.00 0% 0% 0.00
DHFSH08380 Staircase Epoxy Flooring 2.00 24-Mar-15 25-Mar-15 14-Dec-14 15-Dec-14 91.00 0% 0% 0.00
General 264.00 26-Apr-14 11-Jun-15 19-Apr-14 A 06-Aug-15 -43.00 0% 0% 0.00
DHSTR08000 Access from Structure 0.00 26-Apr-14 19-Apr-14 A 100% 100% 0.00
DHFSH08510 Snagging & De-Snagging 12.00 30-May-15 11-Jun-15 25-Jul-15 06-Aug-15 -43.00 0% 0% 0.00
MEP - LEVEL 08 400.00 24-Mar-14 09-May-15 16-Mar-14 A 02-Jul-15 -43.00 72.62% 70.81% 0.98
DHMEP08000 Embeded Conduits & Boxex - Concrete Works 4.00 24-Mar-14 27-Mar-14 16-Mar-14 A 24-Mar-14 A 100% 100% 0.00
DHMEP08100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C27a-bAlipnrg-1 ,4 Wiring et1c7-May-14 19-Apr-14 A 27-May-14 A 100% 100% 1.00
DHMEP08130 Cable Trays & Cable Trunking 6.00 26-May-14 02-Jun-14 19-Apr-14 A 27-May-14 A 100% 100% 0.00
DHMEP08120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 01-Jun-14 07-Jun-14 07-Jun-14 A 19-Jun-14 A 100% 100% 1.00
DHMEP08160 Pressure Testing of Pipes 12.00 08-Jun-14 21-Jun-14 17-May-14 A 21-Jul-14 A 100% 100% 0.00
DHMEP08110 MEP Works in Risers& Clearance 5.00 23-Jul-14 30-Jul-14 19-Apr-14 A 06-Oct-14 -33.00 100% 78% 0.00
DHMEP08140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es17-Sep-14 24-Sep-14 01-Jul-14 A 04-Nov-14 5.00 100% 68% 0.68
DHMEP08150 MEP Final Fixes 6.00 15-Apr-15 21-Apr-15 13-Jun-15 18-Jun-15 -41.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 9 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHMEP06190 Sanitary ware /Toilet accessories 6.00 19-Apr-15 25-Apr-15 16-Jun-15 22-Jun-15 -41.00 0% 0% 0.00
DHMEP08200 Pre-Testing & Commissioning 7.00 02-May-15 09-May-15 25-Jun-15 02-Jul-15 -43.00 0% 0% 0.00
LEVEL 09 431.00 17-Mar-14 18-Jun-15 12-Mar-14 A 13-Aug-15 -43.00 73.77% 69.13% 0.94
STRUCTURAL WORKS -LEVEL 09 19.00 17-Mar-14 07-Apr-14 12-Mar-14 A 08-Apr-14 A 100% 100% 1.00
DHCWA10100 Core Wall - Level 09 10.00 17-Mar-14 27-Mar-14 12-Mar-14 A 27-Mar-14 A 100% 100% 1.00
DHSLA09100 Construction of Horizontals - L09 4.00 31-Mar-14 03-Apr-14 25-Mar-14 A 03-Apr-14 A 100% 100% 1.00
DHCWA10110 Construction of Verticals - L09 3.00 05-Apr-14 07-Apr-14 03-Apr-14 A 08-Apr-14 A 100% 100% 1.00
STAIRCASES 4.00 14-Jun-14 17-Jun-14 19-Jun-14 A 23-Jun-14 A 0% 0% 0.00
A1360 Stair # 1 4.00 14-Jun-14 17-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00
A1370 Stair # 2 4.00 14-Jun-14 17-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 09 283.00 01-May-14 18-Jun-15 12-May-14 A 13-Aug-15 -43.00 37.84% 19.77% 0.52
Dry area 246.00 24-May-14 24-May-15 28-May-14 A 23-Jul-15 -37.00 38.95% 35.49% 0.91
DHFSH09100 Block Work in Dry Area 6.00 24-May-14 31-May-14 28-May-14 A 15-Jun-14 A 100% 100% 1.00
DHFSH09120 Marking,Cutting & Chasing - Dry Area 4.00 01-Jun-14 04-Jun-14 05-Jun-14 A 22-Jun-14 A 100% 100% 1.00
DHFSH09130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 05-Jun-14 09-Jun-14 05-Jul-14 A 15-Jul-14 A 100% 100% 1.00
DHFSH09160 Plaster in Dry Area 8.00 29-Jun-14 08-Jul-14 10-Jul-14 A 24-Aug-14 A 100% 100% 1.00
DHFSH09190 Dry Area Floor Screed 7.00 08-Jul-14 16-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00
DHFSH09230 Dry Area Painting - Primer 4.00 16-Jul-14 21-Jul-14 09-Sep-14 A 01-Oct-14 63.00 100% 80% 0.00
DHFSH09260 Dry Area Painting - Stucco 6.00 21-Jul-14 30-Jul-14 14-Sep-14 A 06-Oct-14 63.00 100% 60% 0.00
DHFSH09290 Dry Area False Ceiling Suspension 6.00 06-Sep-14 13-Sep-14 18-Oct-14 23-Oct-14 -8.00 100% 0% 0.00
DHFSH09350 Dry Area False Ceiling Tiling / Boarding 5.00 29-Sep-14 07-Oct-14 11-Nov-14 16-Nov-14 29.00 22.5% 0% 0.00
DHFSH09400 Dry Area Painting - 1st Coat 5.00 07-Oct-14 13-Oct-14 17-Nov-14 22-Nov-14 29.00 0% 0% 0.00
DHFSH09450 Dry Area Flooring 5.00 30-Oct-14 05-Nov-14 04-Dec-14 09-Dec-14 20.00 0% 0% 0.00
DHFSH09430 Installation of Timber Doors & Ironmongery 5.00 08-Apr-15 13-Apr-15 07-Jun-15 11-Jun-15 -50.00 0% 0% 0.00
DHFSH09802 Installation of Wardrobe 12.00 03-May-15 17-May-15 01-Jul-15 14-Jul-15 -50.00 0% 0% 0.00
DHFSH09500 Paint Final Coat 6.00 18-May-15 24-May-15 15-Jul-15 23-Jul-15 -37.00 0% 0% 0.00
Wet area 232.00 24-May-14 17-May-15 28-May-14 A 14-Jul-15 -50.00 35.69% 10.5% 0.29
DHFSH09110 Block Work in Wet Area 6.00 24-May-14 31-May-14 28-May-14 A 15-Jun-14 A 100% 100% 0.00
DHFSH09140 Marking,Cutting & Chasing - Wet Area 4.00 01-Jun-14 04-Jun-14 05-Jun-14 A 22-Jun-14 A 100% 100% 1.00
DHFSH09150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 05-Jun-14 09-Jun-14 05-Jul-14 A 15-Jul-14 A 100% 100% 1.00
DHFSH09170 Plaster in Wet Area 4.00 23-Jun-14 28-Jun-14 10-Jul-14 A 24-Aug-14 A 100% 100% 1.00
DHFSH09180 Wet Area Wall Tiling 6.00 06-Sep-14 13-Sep-14 13-Oct-14 19-Oct-14 1.00 100% 0% 0.00
DHFSH09300 Wet Area False Ceiling Suspension 5.00 13-Sep-14 18-Sep-14 26-Oct-14 30-Oct-14 5.00 100% 0% 0.00
DHFSH09370 Wet Area False Ceiling Tiling/Boarding 4.00 29-Sep-14 06-Oct-14 11-Nov-14 15-Nov-14 5.00 28.13% 0% 0.00
DHFSH09210 Wet Area Waterproofing 4.00 06-Oct-14 11-Oct-14 16-Nov-14 19-Nov-14 5.00 0% 0% 0.00
DHFSH09220 Wet Area Floor Screed 4.00 11-Oct-14 15-Oct-14 20-Nov-14 24-Nov-14 5.00 0% 0% 0.00
DHFSH09250 Wet Area Floor Tiling 5.00 15-Oct-14 21-Oct-14 25-Nov-14 30-Nov-14 5.00 0% 0% 0.00
DHFSH06530 Cabinet Carcass 5.00 05-Nov-14 10-Nov-14 04-Dec-14 09-Dec-14 3.00 0% 0% 0.00
DHFSH07020 Installation of Shower Enclosure 4.00 14-Apr-15 18-Apr-15 13-Jun-15 16-Jun-15 -39.00 0% 0% 0.00
DHFSH09390 Installation of Vanity Counters & Tops 5.00 14-Apr-15 19-Apr-15 13-Jun-15 17-Jun-15 -50.00 0% 0% 0.00
DHFSH09800 Installation of Kitchen Cabinet 12.00 03-May-15 17-May-15 01-Jul-15 14-Jul-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 87.00 16-Jul-14 21-Mar-15 01-Sep-14 A 23-Dec-14 118.00 37.44% 0% 0.00
DHFSH09240 Corridor/Lift Lobby Floor Screed 4.00 16-Jul-14 21-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00
DHFSH09270 Lift Lobby Painting - Primer & Stucco 6.00 21-Jul-14 30-Jul-14 09-Sep-14 A 02-Oct-14 26.00 100% 65% 0.00
DHFSH09310 Lift Lobby False Ceiling Suspension 6.00 18-Sep-14 25-Sep-14 01-Nov-14 06-Nov-14 5.00 100% 0% 0.00
DHFSH09360 Lift Lobby False Ceiling Tiling / Boarding 5.00 29-Sep-14 07-Oct-14 11-Nov-14 16-Nov-14 112.00 22.5% 0% 0.00
DHFSH09410 Lift Lobby Painting - 1st Coat 6.00 07-Oct-14 14-Oct-14 17-Nov-14 23-Nov-14 112.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - Level 09
Construction of Horizontals - L09
Construction of Verticals - L09
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 10 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH09440 Installation of Steel Doors & Windows 3.00 18-Mar-15 21-Mar-15 10-Dec-14 13-Dec-14 83.00 0% 0% 0.00
DHFSH09470 Lift Lobby Flooring 6.00 05-Nov-14 12-Nov-14 10-Dec-14 16-Dec-14 118.00 0% 0% 0.00
DHFSH09490 Utility Rooms- Epoxy Flooring 6.00 12-Nov-14 19-Nov-14 17-Dec-14 23-Dec-14 118.00 0% 0% 0.00
Staircase 66.00 08-Jul-14 29-Mar-15 01-Oct-14 21-Dec-14 91.00 45.08% 0% 0.00
DHFSH09200 Staircase Plastering 4.00 08-Jul-14 13-Jul-14 01-Oct-14 07-Oct-14 130.00 100% 0% 0.00
DHFSH09280 Staircase Painting - Primer & Stucco 6.00 30-Jul-14 06-Aug-14 08-Oct-14 14-Oct-14 130.00 100% 0% 0.00
DHFSH09320 Staircase Handrail Fixing 3.00 15-Dec-14 18-Dec-14 27-Oct-14 29-Oct-14 125.00 0% 0% 0.00
DHFSH09330 Staircase Painting 1st Coat 3.00 18-Dec-14 22-Dec-14 23-Nov-14 25-Nov-14 105.00 0% 0% 0.00
DHFSH09340 Staircase Final Painting 5.00 22-Mar-15 26-Mar-15 14-Dec-14 18-Dec-14 91.00 0% 0% 0.00
DHFSH09380 Staircase Epoxy Flooring 2.00 28-Mar-15 29-Mar-15 20-Dec-14 21-Dec-14 91.00 0% 0% 0.00
General 270.00 01-May-14 18-Jun-15 12-May-14 A 13-Aug-15 -43.00 0% 0% 0.00
DHSTR09000 Access from Structure 0.00 01-May-14 12-May-14 A 100% 100% 0.00
DHFSH09510 Snagging & De-Snagging 12.00 06-Jun-15 18-Jun-15 01-Aug-15 13-Aug-15 -43.00 0% 0% 0.00
MEP - LEVEL 09 402.00 31-Mar-14 17-May-15 25-Mar-14 A 09-Jul-15 -43.00 71.82% 70.75% 0.99
DHMEP09000 Embeded Conduits & Boxex - Concrete Works 4.00 31-Mar-14 03-Apr-14 25-Mar-14 A 03-Apr-14 A 100% 100% 0.00
DHMEP09100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C03a-bMlianyg- ,1 4Wiring et2c2-May-14 12-May-14 A 14-Jun-14 A 100% 100% 1.00
DHMEP09130 Cable Trays & Cable Trunking 6.00 01-Jun-14 07-Jun-14 12-May-14 A 14-Jun-14 A 100% 100% 0.00
DHMEP09160 Pressure Testing of Pipes 12.00 12-Jun-14 25-Jun-14 07-Jun-14 A 27-Jul-14 A 100% 100% 0.00
DHMEP09120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 05-Jun-14 11-Jun-14 17-Jun-14 A 20-Aug-14 A 100% 100% 1.00
DHMEP09110 MEP Works in Risers& Clearance 5.00 27-Jul-14 03-Aug-14 12-May-14 A 09-Oct-14 -33.00 100% 78% 0.00
DHMEP09140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es22-Sep-14 29-Sep-14 29-Jul-14 A 10-Nov-14 5.00 100% 63% 0.63
DHMEP09150 MEP Final Fixes 6.00 20-Apr-15 26-Apr-15 18-Jun-15 24-Jun-15 -40.00 0% 0% 0.00
DHMEP06210 Sanitary ware /Toilet accessories 6.00 23-Apr-15 29-Apr-15 22-Jun-15 28-Jun-15 -40.00 0% 0% 0.00
DHMEP09200 Pre-Testing & Commissioning 7.00 09-May-15 17-May-15 02-Jul-15 09-Jul-15 -43.00 0% 0% 0.00
LEVEL 10 432.00 29-Mar-14 25-Jun-15 24-Feb-14 A 20-Aug-15 -43.00 72.28% 69.07% 0.96
STRUCTURAL WORKS -LEVEL 10 15.00 29-Mar-14 14-Apr-14 29-Mar-14 A 15-Apr-14 A 100% 100% 1.00
DHCWA11100 Core Wall - Level 10 4.00 29-Mar-14 01-Apr-14 29-Mar-14 A 06-Apr-14 A 100% 100% 1.00
DHSLA10100 Construction of Horizontals - L10 4.00 07-Apr-14 10-Apr-14 05-Apr-14 A 10-Apr-14 A 100% 100% 1.00
DHCWA11110 Construction of Verticals - L10 3.00 12-Apr-14 14-Apr-14 13-Apr-14 A 15-Apr-14 A 100% 100% 1.00
STAIRCASES 4.00 19-Jun-14 23-Jun-14 19-Jun-14 A 23-Jun-14 A 0% 0% 0.00
A1380 Stair # 1 4.00 19-Jun-14 23-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00
A1390 Stair # 2 4.00 19-Jun-14 23-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 10 276.00 07-May-14 25-Jun-15 24-Feb-14 A 20-Aug-15 -43.00 36.53% 19.64% 0.54
Dry area 252.00 01-Jun-14 31-May-15 24-Feb-14 A 30-Jul-15 -37.00 38.17% 35.49% 0.93
DHFSH10190 Dry Area Floor Screed 7.00 13-Jul-14 21-Jul-14 24-Feb-14 A 24-Feb-14 A 100% 100% 0.00
DHFSH10100 Block Work in Dry Area 6.00 01-Jun-14 07-Jun-14 02-Jun-14 A 17-Jun-14 A 100% 100% 1.00
DHFSH10120 Marking,Cutting & Chasing - Dry Area 4.00 08-Jun-14 11-Jun-14 15-Jun-14 A 24-Jun-14 A 100% 100% 1.00
DHFSH10130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 12-Jun-14 16-Jun-14 08-Jul-14 A 19-Jul-14 A 100% 100% 1.00
DHFSH10160 Plaster in Dry Area 8.00 03-Jul-14 13-Jul-14 13-Jul-14 A 25-Aug-14 A 100% 100% 1.00
DHFSH10230 Dry Area Painting - Primer 4.00 21-Jul-14 26-Jul-14 15-Sep-14 A 01-Oct-14 67.00 100% 80% 0.00
DHFSH10260 Dry Area Painting - Stucco 6.00 26-Jul-14 04-Aug-14 20-Sep-14 A 06-Oct-14 67.00 100% 60% 0.00
DHFSH10290 Dry Area False Ceiling Suspension 6.00 10-Sep-14 17-Sep-14 01-Nov-14 06-Nov-14 -15.00 100% 0% 0.00
DHFSH10350 Dry Area False Ceiling Tiling / Boarding / Boarding 5.00 04-Nov-14 09-Nov-14 24-Nov-14 29-Nov-14 22.00 0% 0% 0.00
DHFSH10400 Dry Area Painting - 1st Coat 6.00 10-Nov-14 16-Nov-14 30-Nov-14 07-Dec-14 22.00 0% 0% 0.00
DHFSH10450 Dry Area Flooring 5.00 24-Nov-14 29-Nov-14 15-Dec-14 20-Dec-14 16.00 0% 0% 0.00
DHFSH10430 Installation of Timber Doors & Ironmongery 5.00 14-Apr-15 19-Apr-15 13-Jun-15 17-Jun-15 -50.00 0% 0% 0.00
DHFSH10802 Installation of Wardrobe 12.00 10-May-15 24-May-15 08-Jul-15 23-Jul-15 -50.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Pressure Testing of Pipes
Embeded Condiuts,Boxes and Sleeves in Walls
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - Level 10
Construction of Horizontals - L10
Construction of Verticals - L10
Stair # 1
Stair # 2
Dry Area Floor Screed
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 11 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH10500 Paint Final Coat 6.00 25-May-15 31-May-15 25-Jul-15 30-Jul-15 -37.00 0% 0% 0.00
Wet area 234.00 01-Jun-14 24-May-15 02-Jun-14 A 23-Jul-15 -50.00 34.32% 10.35% 0.30
DHFSH10110 Block Work in Wet Area 6.00 01-Jun-14 07-Jun-14 02-Jun-14 A 17-Jun-14 A 100% 100% 0.00
DHFSH10140 Marking,Cutting & Chasing - Wet Area 4.00 08-Jun-14 11-Jun-14 15-Jun-14 A 24-Jun-14 A 100% 100% 1.00
DHFSH10150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 12-Jun-14 16-Jun-14 08-Jul-14 A 19-Jul-14 A 100% 100% 1.00
DHFSH10170 Plaster in Wet Area 4.00 26-Jun-14 01-Jul-14 13-Jul-14 A 25-Aug-14 A 100% 100% 1.00
DHFSH10180 Wet Area Wall Tiling 6.00 10-Sep-14 17-Sep-14 18-Oct-14 23-Oct-14 1.00 100% 0% 0.00
DHFSH10300 Wet Area False Ceiling Suspension 5.00 17-Sep-14 23-Sep-14 08-Nov-14 12-Nov-14 -1.00 100% 0% 0.00
DHFSH10370 Wet Area False Ceiling Tiling/Boarding 4.00 04-Nov-14 08-Nov-14 24-Nov-14 27-Nov-14 -1.00 0% 0% 0.00
DHFSH10210 Wet Area Waterproofing 4.00 09-Nov-14 12-Nov-14 29-Nov-14 03-Dec-14 -1.00 0% 0% 0.00
DHFSH10220 Wet Area Floor Screed 4.00 13-Nov-14 17-Nov-14 04-Dec-14 08-Dec-14 -1.00 0% 0% 0.00
DHFSH10250 Wet Area Floor Tiling 5.00 18-Nov-14 23-Nov-14 09-Dec-14 14-Dec-14 -1.00 0% 0% 0.00
DHFSH06540 Cabinet Carcass 6.00 24-Nov-14 30-Nov-14 15-Dec-14 21-Dec-14 -1.00 0% 0% 0.00
DHFSH10390 Installation of Vanity Counters & Tops 5.00 20-Apr-15 25-Apr-15 18-Jun-15 23-Jun-15 -50.00 0% 0% 0.00
DHFSH10420 Installation of Shower Enclosure 4.00 26-Apr-15 29-Apr-15 24-Jun-15 28-Jun-15 -44.00 0% 0% 0.00
DHFSH10800 Installation of Kitchen Cabinet 12.00 10-May-15 24-May-15 08-Jul-15 23-Jul-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 77.00 21-Jul-14 24-Mar-15 01-Sep-14 A 04-Jan-15 111.00 28.95% 0% 0.00
DHFSH10240 Corridor/Lift Lobby Floor Screed 4.00 21-Jul-14 26-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00
DHFSH10270 Lift Lobby Painting - Primer & Stucco 6.00 26-Jul-14 04-Aug-14 15-Sep-14 A 06-Oct-14 30.00 100% 55% 0.00
DHFSH10310 Lift Lobby False Ceiling Suspension 6.00 23-Sep-14 30-Sep-14 13-Nov-14 19-Nov-14 -1.00 100% 0% 0.00
DHFSH10360 Lift Lobby False Ceiling Tiling / Boarding 5.00 04-Nov-14 09-Nov-14 24-Nov-14 29-Nov-14 104.00 0% 0% 0.00
DHFSH10410 Lift Lobby Painting - 1st Coat 6.00 10-Nov-14 16-Nov-14 30-Nov-14 07-Dec-14 104.00 0% 0% 0.00
DHFSH10440 Installation of Steel Doors & Windows 3.00 22-Mar-15 24-Mar-15 22-Dec-14 24-Dec-14 76.00 0% 0% 0.00
DHFSH10470 Lift Lobby Flooring 6.00 30-Nov-14 07-Dec-14 21-Dec-14 27-Dec-14 111.00 0% 0% 0.00
DHFSH10490 Utility Rooms- Epoxy Flooring 6.00 08-Dec-14 14-Dec-14 28-Dec-14 04-Jan-15 111.00 0% 0% 0.00
Staircase 76.00 13-Jul-14 01-Apr-15 01-Oct-14 03-Jan-15 86.00 45.08% 0% 0.00
DHFSH10200 Staircase Plastering 4.00 13-Jul-14 17-Jul-14 01-Oct-14 07-Oct-14 133.00 100% 0% 0.00
DHFSH10280 Staircase Painting - Primer & Stucco 6.00 04-Aug-14 11-Aug-14 08-Oct-14 14-Oct-14 133.00 100% 0% 0.00
DHFSH10320 Staircase Handrail Fixing 3.00 18-Dec-14 22-Dec-14 30-Oct-14 02-Nov-14 127.00 0% 0% 0.00
DHFSH10330 Staircase Painting 1st Coat 3.00 22-Dec-14 25-Dec-14 08-Dec-14 10-Dec-14 98.00 0% 0% 0.00
DHFSH10340 Staircase Final Painting 5.00 25-Mar-15 30-Mar-15 25-Dec-14 30-Dec-14 86.00 0% 0% 0.00
DHFSH10380 Staircase Epoxy Flooring 2.00 31-Mar-15 01-Apr-15 31-Dec-14 03-Jan-15 86.00 0% 0% 0.00
General 276.00 07-May-14 25-Jun-15 17-May-14 A 20-Aug-15 -43.00 0% 0% 0.00
DHSTR10000 Access from Structure 0.00 07-May-14 17-May-14 A 100% 100% 0.00
DHFSH10510 Snagging & De-Snagging 12.00 13-Jun-15 25-Jun-15 08-Aug-15 20-Aug-15 -43.00 0% 0% 0.00
MEP - LEVEL 10 404.00 07-Apr-14 23-May-15 05-Apr-14 A 16-Jul-15 -44.00 69.07% 70.81% 1.03
DHMEP10000 Embeded Conduits & Boxex - Concrete Works 4.00 07-Apr-14 10-Apr-14 05-Apr-14 A 10-Apr-14 A 100% 100% 0.00
DHMEP10100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C08a-bMlianyg- ,1 4Wiring et2c9-May-14 19-May-14 A 19-Jun-14 A 100% 100% 1.00
DHMEP10130 Cable Trays & Cable Trunking 6.00 08-Jun-14 14-Jun-14 19-May-14 A 19-Jun-14 A 100% 100% 0.00
DHMEP10160 Pressure Testing of Pipes 12.00 19-Jun-14 02-Jul-14 09-Jun-14 A 30-Jul-14 A 100% 100% 0.00
DHMEP10120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 12-Jun-14 18-Jun-14 24-Jun-14 A 24-Aug-14 A 100% 100% 1.00
DHMEP10110 MEP Works in Risers& Clearance 5.00 04-Aug-14 09-Aug-14 17-May-14 A 11-Oct-14 -33.00 100% 78% 0.00
DHMEP10140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es28-Oct-14 03-Nov-14 02-Aug-14 A 23-Nov-14 -1.00 0% 60% 0.00
DHMEP10150 MEP Final Fixes 6.00 30-Apr-15 06-May-15 29-Jun-15 05-Jul-15 -44.00 0% 0% 0.00
DHMEP06220 Sanitary ware /Toilet accessories 6.00 04-May-15 10-May-15 02-Jul-15 08-Jul-15 -44.00 0% 0% 0.00
DHMEP10200 Pre-Testing & Commissioning 7.00 14-May-15 23-May-15 09-Jul-15 16-Jul-15 -44.00 0% 0% 0.00
LEVEL 11 480.00 02-Apr-14 02-Jul-15 24-Feb-14 A 28-Sep-15 -68.00 72.14% 68.82% 0.95
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Vanity Counters & Tops
Installation of Shower Enclosure
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Pressure Testing of Pipes
Embeded Condiuts,Boxes and Sleeves in Walls
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 12 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
STRUCTURAL WORKS -LEVEL 11 16.00 02-Apr-14 20-Apr-14 07-Apr-14 A 21-Apr-14 A 100% 100% 1.00
DHCWA12100 Core Wall - Level 11 4.00 02-Apr-14 06-Apr-14 07-Apr-14 A 08-Apr-14 A 100% 100% 1.00
DHSLA11100 Construction of Horizontals - L11 4.00 14-Apr-14 17-Apr-14 12-Apr-14 A 17-Apr-14 A 100% 100% 1.00
DHCWA12110 Construction of Verticals - L11 2.00 19-Apr-14 20-Apr-14 18-Apr-14 A 21-Apr-14 A 100% 100% 1.00
STAIRCASES 4.00 25-Jun-14 29-Jun-14 19-Jun-14 A 23-Jun-14 A 0% 0% 0.00
A1400 Stair # 1 4.00 25-Jun-14 29-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00
A1410 Stair # 2 4.00 25-Jun-14 29-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 11 282.00 13-May-14 02-Jul-15 24-Feb-14 A 27-Aug-15 -43.00 35.81% 19.64% 0.55
Dry area 258.00 05-Jun-14 07-Jun-15 24-Feb-14 A 06-Aug-15 -37.00 38.17% 35.49% 0.93
DHFSH11190 Dry Area Floor Screed 7.00 17-Jul-14 26-Jul-14 24-Feb-14 A 24-Feb-14 A 100% 100% 0.00
DHFSH11100 Block Work in Dry Area 6.00 05-Jun-14 11-Jun-14 14-Jun-14 A 23-Jun-14 A 100% 100% 1.00
DHFSH11120 Marking,Cutting & Chasing - Dry Area 4.00 12-Jun-14 16-Jun-14 30-Jun-14 A 05-Jul-14 A 100% 100% 1.00
DHFSH11130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 17-Jun-14 21-Jun-14 09-Jul-14 A 13-Jul-14 A 100% 100% 1.00
DHFSH11160 Plaster in Dry Area 8.00 08-Jul-14 17-Jul-14 02-Aug-14 A 25-Aug-14 A 100% 100% 1.00
DHFSH11230 Dry Area Painting - Primer 4.00 26-Jul-14 02-Aug-14 18-Sep-14 A 01-Oct-14 71.00 100% 80% 0.00
DHFSH11260 Dry Area Painting - Stucco 6.00 02-Aug-14 09-Aug-14 23-Sep-14 A 08-Oct-14 71.00 100% 40% 0.00
DHFSH11290 Dry Area False Ceiling Suspension 7.00 14-Sep-14 22-Sep-14 04-Nov-14 11-Nov-14 -15.00 100% 0% 0.00
DHFSH11350 Dry Area False Ceiling Tiling / Boarding 5.00 08-Nov-14 12-Nov-14 29-Nov-14 04-Dec-14 24.00 0% 0% 0.00
DHFSH11400 Dry Area Painting - 1st Coat 5.00 13-Nov-14 18-Nov-14 06-Dec-14 10-Dec-14 24.00 0% 0% 0.00
DHFSH11450 Dry Area Flooring 5.00 30-Nov-14 06-Dec-14 21-Dec-14 25-Dec-14 16.00 0% 0% 0.00
DHFSH11430 Installation of Timber Doors & Ironmongery 5.00 19-Apr-15 23-Apr-15 17-Jun-15 22-Jun-15 -50.00 0% 0% 0.00
DHFSH11802 Installation of Wardrobe 12.00 18-May-15 31-May-15 15-Jul-15 30-Jul-15 -50.00 0% 0% 0.00
DHFSH11500 Paint Final Coat 6.00 01-Jun-15 07-Jun-15 01-Aug-15 06-Aug-15 -37.00 0% 0% 0.00
Wet area 236.00 05-Jun-14 31-May-15 14-Jun-14 A 30-Jul-15 -50.00 34.32% 10.35% 0.30
DHFSH11110 Block Work in Wet Area 6.00 05-Jun-14 11-Jun-14 14-Jun-14 A 23-Jun-14 A 100% 100% 0.00
DHFSH11140 Marking,Cutting & Chasing - Wet Area 4.00 12-Jun-14 16-Jun-14 30-Jun-14 A 05-Jul-14 A 100% 100% 1.00
DHFSH11150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 17-Jun-14 21-Jun-14 09-Jul-14 A 13-Jul-14 A 100% 100% 1.00
DHFSH11170 Plaster in Wet Area 4.00 30-Jun-14 05-Jul-14 02-Aug-14 A 25-Aug-14 A 100% 100% 1.00
DHFSH11180 Wet Area Wall Tiling 6.00 15-Sep-14 22-Sep-14 22-Oct-14 29-Oct-14 1.00 100% 0% 0.00
DHFSH11300 Wet Area False Ceiling Suspension 5.00 22-Sep-14 28-Sep-14 12-Nov-14 17-Nov-14 1.00 100% 0% 0.00
DHFSH11370 Wet Area False Ceiling Tiling/Boarding 4.00 08-Nov-14 11-Nov-14 29-Nov-14 03-Dec-14 1.00 0% 0% 0.00
DHFSH11210 Wet Area Waterproofing 4.00 12-Nov-14 16-Nov-14 04-Dec-14 08-Dec-14 1.00 0% 0% 0.00
DHFSH11220 Wet Area Floor Screed 4.00 17-Nov-14 20-Nov-14 09-Dec-14 13-Dec-14 1.00 0% 0% 0.00
DHFSH11250 Wet Area Floor Tiling 5.00 22-Nov-14 26-Nov-14 14-Dec-14 18-Dec-14 1.00 0% 0% 0.00
DHFSH06550 Cabinet Carcass 5.00 01-Dec-14 07-Dec-14 22-Dec-14 27-Dec-14 -1.00 0% 0% 0.00
DHFSH11390 Installation of Vanity Counters & Tops 5.00 26-Apr-15 30-Apr-15 24-Jun-15 29-Jun-15 -50.00 0% 0% 0.00
DHFSH11420 Installation of Shower Enclosure 4.00 29-Apr-15 03-May-15 28-Jun-15 01-Jul-15 -41.00 0% 0% 0.00
DHFSH11800 Installation of Kitchen Cabinet 12.00 18-May-15 31-May-15 15-Jul-15 30-Jul-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 82.00 26-Jul-14 28-Mar-15 01-Sep-14 A 10-Jan-15 108.00 10.25% 0% 0.00
DHFSH11240 Corridor/Lift Lobby Floor Screed 4.00 26-Jul-14 02-Aug-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00
DHFSH11270 Lift Lobby Painting - Primer & Stucco 6.00 02-Aug-14 09-Aug-14 18-Sep-14 A 06-Oct-14 36.00 100% 50% 0.00
DHFSH11310 Lift Lobby False Ceiling Suspension 6.00 28-Sep-14 07-Oct-14 18-Nov-14 24-Nov-14 1.00 35.42% 0% 0.00
DHFSH11360 Lift Lobby False Ceiling Tiling / Boarding 5.00 08-Nov-14 12-Nov-14 29-Nov-14 04-Dec-14 103.00 0% 0% 0.00
DHFSH11410 Lift Lobby Painting - 1st Coat 6.00 13-Nov-14 19-Nov-14 06-Dec-14 11-Dec-14 103.00 0% 0% 0.00
DHFSH11440 Installation of Steel Doors & Windows 3.00 25-Mar-15 28-Mar-15 28-Dec-14 30-Dec-14 74.00 0% 0% 0.00
DHFSH11470 Lift Lobby Flooring 6.00 07-Dec-14 13-Dec-14 27-Dec-14 03-Jan-15 108.00 0% 0% 0.00
DHFSH11490 Utility Rooms- Epoxy Flooring 6.00 14-Dec-14 20-Dec-14 04-Jan-15 10-Jan-15 108.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Core Wall - Level 11
Construction of Horizontals - L11
Construction of Verticals - L11
Stair # 1
Stair # 2
Dry Area Floor Screed
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Vanity Counters & Tops
Installation of Shower Enclosure
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 13 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
Staircase 81.00 17-Jul-14 05-Apr-15 01-Oct-14 08-Jan-15 85.00 45.08% 0% 0.00
DHFSH11200 Staircase Plastering 4.00 17-Jul-14 22-Jul-14 01-Oct-14 07-Oct-14 136.00 100% 0% 0.00
DHFSH11280 Staircase Painting - Primer & Stucco 6.00 09-Aug-14 16-Aug-14 08-Oct-14 14-Oct-14 136.00 100% 0% 0.00
DHFSH11320 Staircase Handrail Fixing 3.00 22-Dec-14 25-Dec-14 03-Nov-14 05-Nov-14 128.00 0% 0% 0.00
DHFSH11330 Staircase Painting 1st Coat 3.00 25-Dec-14 29-Dec-14 11-Dec-14 14-Dec-14 99.00 0% 0% 0.00
DHFSH11340 Staircase Final Painting 5.00 29-Mar-15 02-Apr-15 31-Dec-14 06-Jan-15 85.00 0% 0% 0.00
DHFSH11380 Staircase Epoxy Flooring 2.00 04-Apr-15 05-Apr-15 07-Jan-15 08-Jan-15 85.00 0% 0% 0.00
General 282.00 13-May-14 02-Jul-15 24-May-14 A 27-Aug-15 -43.00 0% 0% 0.00
DHSTR11000 Access from Structure 0.00 13-May-14 24-May-14 A 100% 100% 0.00
DHFSH11510 Snagging & De-Snagging 12.00 20-Jun-15 02-Jul-15 15-Aug-15 27-Aug-15 -43.00 0% 0% 0.00
MEP - LEVEL 11 480.00 15-Apr-14 30-May-15 12-Apr-14 A 28-Sep-15 -97.00 69.07% 70.11% 1.02
DHMEP11000 Embeded Conduits & Boxex - Concrete Works 3.00 15-Apr-14 17-Apr-14 12-Apr-14 A 17-Apr-14 A 100% 100% 0.00
DHMEP11100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C14a-bMlianyg- ,1 4Wiring et0c4-Jun-14 26-May-14 A 30-Jun-14 A 100% 100% 1.00
DHMEP11130 Cable Trays & Cable Trunking 6.00 12-Jun-14 18-Jun-14 26-May-14 A 30-Jun-14 A 100% 100% 0.00
DHMEP11160 Pressure Testing of Pipes 12.00 24-Jun-14 07-Jul-14 30-Jul-14 A 26-Aug-14 A 100% 100% 0.00
DHMEP11120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 17-Jun-14 23-Jun-14 05-Jul-14 A 30-Aug-14 A 100% 100% 1.00
DHMEP11110 MEP Works in Risers& Clearance 5.00 09-Aug-14 13-Aug-14 24-May-14 A 15-Oct-14 -33.00 100% 76% 0.00
DHMEP11140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es01-Nov-14 06-Nov-14 04-Aug-14 A 27-Nov-14 1.00 0% 36% 0.00
DHMEP11150 MEP Final Fixes 6.00 07-May-15 13-May-15 06-Jul-15 12-Jul-15 -44.00 0% 0% 0.00
DHMEP06230 Sanitary ware /Toilet accessories 6.00 11-May-15 18-May-15 09-Jul-15 15-Jul-15 -44.00 0% 0% 0.00
DHMEP11200 Pre-Testing & Commissioning 7.00 23-May-15 30-May-15 16-Jul-15 26-Jul-15 -44.00 0% 0% 0.00
DHMEP11010 Busbar - L11to L15 20.00 12-Mar-15 04-Apr-15 03-Sep-15 28-Sep-15 -144.00 0% 0% 0.00
LEVEL 12 457.00 07-Apr-14 09-Jul-15 24-Feb-14 A 03-Sep-15 -43.00 71.98% 68.79% 0.96
STRUCTURAL WORKS -LEVEL 12 144.00 07-Apr-14 27-Apr-14 06-Apr-14 A 28-Apr-14 A 100% 100% 1.00
DHCWA13120 Tower Crane Jump 1.00 13-Apr-14 13-Apr-14 06-Apr-14 A 06-Apr-14 A 100% 100% 0.00
DHCWA13100 Core Wall - Level 12 6.00 07-Apr-14 13-Apr-14 10-Apr-14 A 14-Apr-14 A 100% 100% 1.00
DHSLA12100 Construction of Horizontals - L12 4.00 21-Apr-14 24-Apr-14 19-Apr-14 A 24-Apr-14 A 100% 100% 1.00
DHCWA13110 Construction of Verticals - L12 2.00 26-Apr-14 27-Apr-14 25-Apr-14 A 28-Apr-14 A 100% 100% 1.00
STAIRCASES 4.00 03-Jul-14 07-Jul-14 19-Jun-14 A 23-Jun-14 A 0% 0% 0.00
A1420 Stair # 1 4.00 03-Jul-14 07-Jul-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00
A1430 Stair # 2 3.00 05-Jul-14 07-Jul-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 12 288.00 19-May-14 09-Jul-15 24-Feb-14 A 03-Sep-15 -43.00 35% 19.64% 0.56
Dry area 264.00 11-Jun-14 14-Jun-15 24-Feb-14 A 13-Aug-15 -37.00 38.17% 35.49% 0.93
DHFSH12190 Dry Area Floor Screed 7.00 22-Jul-14 02-Aug-14 24-Feb-14 A 24-Feb-14 A 100% 100% 0.00
DHFSH12100 Block Work in Dry Area 6.00 11-Jun-14 17-Jun-14 09-Jun-14 A 02-Jul-14 A 100% 100% 1.00
DHFSH12130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 23-Jun-14 26-Jun-14 13-Jul-14 A 17-Jul-14 A 100% 100% 1.00
DHFSH12120 Marking,Cutting & Chasing - Dry Area 4.00 18-Jun-14 22-Jun-14 06-Jul-14 A 04-Aug-14 A 100% 100% 1.00
DHFSH12160 Plaster in Dry Area 8.00 13-Jul-14 22-Jul-14 06-Aug-14 A 28-Aug-14 A 100% 100% 1.00
DHFSH12230 Dry Area Painting - Primer 4.00 02-Aug-14 06-Aug-14 23-Sep-14 A 02-Oct-14 75.00 100% 60% 0.00
DHFSH12260 Dry Area Painting - Stucco 6.00 06-Aug-14 13-Aug-14 28-Sep-14 A 09-Oct-14 75.00 100% 40% 0.00
DHFSH12290 Dry Area False Ceiling Suspension 7.00 18-Sep-14 27-Sep-14 09-Nov-14 16-Nov-14 -15.00 100% 0% 0.00
DHFSH12350 Dry Area False Ceiling Tiling / Boarding 5.00 11-Nov-14 16-Nov-14 04-Dec-14 09-Dec-14 25.00 0% 0% 0.00
DHFSH12400 Dry Area Painting - 1st Coat 5.00 17-Nov-14 22-Nov-14 10-Dec-14 15-Dec-14 25.00 0% 0% 0.00
DHFSH12450 Dry Area Flooring 5.00 07-Dec-14 11-Dec-14 27-Dec-14 31-Dec-14 16.00 0% 0% 0.00
DHFSH12430 Installation of Timber Doors & Ironmongery 5.00 23-Apr-15 28-Apr-15 22-Jun-15 27-Jun-15 -50.00 0% 0% 0.00
DHFSH12802 Installation of Wardrobe 12.00 23-May-15 04-Jun-15 22-Jul-15 04-Aug-15 -50.00 0% 0% 0.00
DHFSH12500 Paint Final Coat 6.00 08-Jun-15 14-Jun-15 08-Aug-15 13-Aug-15 -37.00 0% 0% 0.00
Wet area 238.00 11-Jun-14 07-Jun-15 09-Jun-14 A 06-Aug-15 -50.00 33.43% 10.35% 0.31
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Pressure Testing of Pipes
Embeded Condiuts,Boxes and Sleeves in Walls
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Busbar - L11to L15
Tower Crane Jump
Core Wall - Level 12
Construction of Horizontals - L12
Construction of Verticals - L12
Stair # 1
Stair # 2
Dry Area Floor Screed
Block Work in Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Marking,Cutting & Chasing - Dry Area
Plaster in Dry Area
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 14 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH12110 Block Work in Wet Area 6.00 11-Jun-14 17-Jun-14 09-Jun-14 A 02-Jul-14 A 100% 100% 0.00
DHFSH12150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 23-Jun-14 26-Jun-14 13-Jul-14 A 17-Jul-14 A 100% 100% 1.00
DHFSH12140 Marking,Cutting & Chasing - Wet Area 4.00 18-Jun-14 22-Jun-14 06-Jul-14 A 04-Aug-14 A 100% 100% 1.00
DHFSH12170 Plaster in Wet Area 4.00 03-Jul-14 08-Jul-14 06-Aug-14 A 28-Aug-14 A 100% 100% 1.00
DHFSH12180 Wet Area Wall Tiling 6.00 20-Sep-14 27-Sep-14 28-Oct-14 03-Nov-14 1.00 100% 0% 0.00
DHFSH12300 Wet Area False Ceiling Suspension 5.00 27-Sep-14 02-Oct-14 17-Nov-14 22-Nov-14 2.00 62.5% 0% 0.00
DHFSH12370 Wet Area False Ceiling Tiling/Boarding 4.00 11-Nov-14 15-Nov-14 04-Dec-14 08-Dec-14 2.00 0% 0% 0.00
DHFSH12210 Wet Area Waterproofing 4.00 16-Nov-14 19-Nov-14 09-Dec-14 13-Dec-14 2.00 0% 0% 0.00
DHFSH12220 Wet Area Floor Screed 4.00 20-Nov-14 24-Nov-14 14-Dec-14 17-Dec-14 2.00 0% 0% 0.00
DHFSH12250 Wet Area Floor Tiling 5.00 25-Nov-14 30-Nov-14 18-Dec-14 23-Dec-14 2.00 0% 0% 0.00
DHFSH06560 Cabinet Carcass 6.00 08-Dec-14 14-Dec-14 28-Dec-14 04-Jan-15 -1.00 0% 0% 0.00
DHFSH12390 Installation of Vanity Counters & Tops 5.00 02-May-15 06-May-15 30-Jun-15 05-Jul-15 -50.00 0% 0% 0.00
DHFSH12420 Installation of Shower Enclosure 4.00 03-May-15 06-May-15 01-Jul-15 05-Jul-15 -40.00 0% 0% 0.00
DHFSH12800 Installation of Kitchen Cabinet 12.00 25-May-15 07-Jun-15 25-Jul-15 06-Aug-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 87.00 02-Aug-14 31-Mar-15 01-Sep-14 A 15-Jan-15 105.00 0% 0% 0.00
DHFSH12240 Corridor/Lift Lobby Floor Screed 4.00 02-Aug-14 06-Aug-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00
DHFSH12270 Lift Lobby Painting - Primer & Stucco 6.00 06-Aug-14 13-Aug-14 23-Sep-14 A 07-Oct-14 40.00 100% 35% 0.00
DHFSH12310 Lift Lobby False Ceiling Suspension 6.00 02-Oct-14 12-Oct-14 23-Nov-14 29-Nov-14 2.00 0% 0% 0.00
DHFSH12360 Lift Lobby False Ceiling Tiling / Boarding 5.00 11-Nov-14 16-Nov-14 04-Dec-14 09-Dec-14 102.00 0% 0% 0.00
DHFSH12410 Lift Lobby Painting - 1st Coat 6.00 17-Nov-14 23-Nov-14 10-Dec-14 16-Dec-14 102.00 0% 0% 0.00
DHFSH12440 Installation of Steel Doors & Windows 3.00 29-Mar-15 31-Mar-15 05-Jan-15 07-Jan-15 71.00 0% 0% 0.00
DHFSH12470 Lift Lobby Flooring 6.00 13-Dec-14 18-Dec-14 03-Jan-15 08-Jan-15 105.00 0% 0% 0.00
DHFSH12490 Utility Rooms- Epoxy Flooring 6.00 20-Dec-14 25-Dec-14 10-Jan-15 15-Jan-15 105.00 0% 0% 0.00
Staircase 87.00 22-Jul-14 08-Apr-15 01-Oct-14 15-Jan-15 83.00 45.08% 0% 0.00
DHFSH12200 Staircase Plastering 4.00 22-Jul-14 27-Jul-14 01-Oct-14 07-Oct-14 139.00 100% 0% 0.00
DHFSH12280 Staircase Painting - Primer & Stucco 6.00 13-Aug-14 20-Aug-14 08-Oct-14 14-Oct-14 139.00 100% 0% 0.00
DHFSH12320 Staircase Handrail Fixing 3.00 25-Dec-14 29-Dec-14 06-Nov-14 09-Nov-14 129.00 0% 0% 0.00
DHFSH12330 Staircase Painting 1st Coat 3.00 29-Dec-14 03-Jan-15 16-Dec-14 18-Dec-14 99.00 0% 0% 0.00
DHFSH12340 Staircase Final Painting 5.00 01-Apr-15 06-Apr-15 08-Jan-15 13-Jan-15 83.00 0% 0% 0.00
DHFSH12380 Staircase Epoxy Flooring 2.00 07-Apr-15 08-Apr-15 14-Jan-15 15-Jan-15 83.00 0% 0% 0.00
General 288.00 19-May-14 09-Jul-15 03-Jun-14 A 03-Sep-15 -43.00 0% 0% 0.00
DHSTR12000 Access from Structure 0.00 19-May-14 03-Jun-14 A 100% 100% 0.00
DHFSH12510 Snagging & De-Snagging 12.00 27-Jun-15 09-Jul-15 22-Aug-15 03-Sep-15 -43.00 0% 0% 0.00
MEP - LEVEL 12 427.00 22-Apr-14 03-Jun-15 19-Apr-14 A 30-Jul-15 -44.00 69.07% 69.97% 1.01
DHMEP12000 Embeded Conduits & Boxex - Concrete Works 3.00 22-Apr-14 24-Apr-14 19-Apr-14 A 24-Apr-14 A 100% 100% 0.00
DHMEP12100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C20a-bMlianyg- ,1 4Wiring et1c0-Jun-14 03-Jun-14 A 22-Jul-14 A 100% 100% 1.00
DHMEP12130 Cable Trays & Cable Trunking 6.00 18-Jun-14 24-Jun-14 03-Jun-14 A 22-Jul-14 A 100% 100% 0.00
DHMEP12120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 23-Jun-14 29-Jun-14 09-Jul-14 A 02-Sep-14 A 100% 100% 1.00
DHMEP12160 Pressure Testing of Pipes 12.00 30-Jun-14 13-Jul-14 30-Jul-14 A 02-Oct-14 47.00 100% 83% 0.00
DHMEP12110 MEP Works in Risers& Clearance 5.00 14-Aug-14 19-Aug-14 03-Jun-14 A 16-Oct-14 -33.00 100% 69% 0.00
DHMEP12140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es04-Nov-14 10-Nov-14 10-Aug-14 A 03-Dec-14 2.00 0% 31% 0.00
DHMEP12150 MEP Final Fixes 6.00 12-May-15 19-May-15 11-Jul-15 16-Jul-15 -44.00 0% 0% 0.00
DHMEP06240 Sanitary ware /Toilet accessories 6.00 17-May-15 23-May-15 14-Jul-15 22-Jul-15 -44.00 0% 0% 0.00
DHMEP12200 Pre-Testing & Commissioning 7.00 27-May-15 03-Jun-15 23-Jul-15 30-Jul-15 -44.00 0% 0% 0.00
LEVEL 13 459.00 14-Apr-14 15-Jul-15 24-Feb-14 A 09-Sep-15 -43.00 71.49% 68.83% 0.96
STRUCTURAL WORKS -LEVEL 13 17.00 14-Apr-14 03-May-14 15-Apr-14 A 05-May-14 A 100% 100% 1.00
DHCWA14100 Core Wall - Level 13 4.00 14-Apr-14 17-Apr-14 15-Apr-14 A 20-Apr-14 A 100% 100% 1.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Block Work in Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Marking,Cutting & Chasing - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Vanity Counters & Tops
Installation of Shower Enclosure
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - Level 13
Data Date : 30-Sep-14
Page : 15 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHSLA13100 Construction of Horizontals - L13 3.00 28-Apr-14 30-Apr-14 25-Apr-14 A 01-May-14 A 100% 100% 1.00
DHCWA14110 Construction of Verticals - L13 2.00 01-May-14 03-May-14 02-May-14 A 05-May-14 A 100% 100% 1.00
STAIRCASES 4.00 12-Jul-14 15-Jul-14 19-Jun-14 A 14-Jul-14 A 0% 0% 0.00
A1450 Stair # 2 3.00 13-Jul-14 15-Jul-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00
A1440 Stair # 1 4.00 12-Jul-14 15-Jul-14 23-Jun-14 A 14-Jul-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 13 293.00 25-May-14 15-Jul-15 24-Feb-14 A 09-Sep-15 -43.00 32.69% 19.64% 0.60
Dry area 270.00 17-Jun-14 21-Jun-15 24-Feb-14 A 20-Aug-15 -38.00 37.83% 35.49% 0.94
DHMEP13190 Dry Area Floor Screed 7.00 27-Jul-14 06-Aug-14 24-Feb-14 A 24-Feb-14 A 100% 100% 0.00
DHFSH13100 Block Work in Dry Area 6.00 17-Jun-14 23-Jun-14 17-Jun-14 A 09-Jul-14 A 100% 100% 1.00
DHFSH13120 Marking,Cutting & Chasing - Dry Area 4.00 24-Jun-14 28-Jun-14 10-Jul-14 A 06-Aug-14 A 100% 100% 1.00
DHFSH13130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 29-Jun-14 02-Jul-14 14-Jul-14 A 07-Aug-14 A 100% 100% 1.00
DHFSH13160 Plaster in Dry Area 8.00 17-Jul-14 27-Jul-14 11-Aug-14 A 28-Aug-14 A 100% 100% 1.00
DHFSH13230 Dry Area Painting - Primer 4.00 06-Aug-14 11-Aug-14 25-Sep-14 A 02-Oct-14 79.00 100% 50% 0.00
DHFSH13260 Dry Area Painting - Stucco 6.00 11-Aug-14 18-Aug-14 29-Sep-14 A 11-Oct-14 79.00 100% 20% 0.00
DHFSH13290 Dry Area False Ceiling Suspension 7.00 23-Sep-14 01-Oct-14 13-Nov-14 20-Nov-14 -15.00 87.5% 0% 0.00
DHFSH13350 Dry Area False Ceiling Tiling / Boarding 5.00 15-Nov-14 19-Nov-14 09-Dec-14 14-Dec-14 26.00 0% 0% 0.00
DHFSH13400 Dry Area Painting - 1st Coat 5.00 20-Nov-14 25-Nov-14 15-Dec-14 20-Dec-14 26.00 0% 0% 0.00
DHFSH13450 Dry Area Flooring 5.00 13-Dec-14 17-Dec-14 03-Jan-15 07-Jan-15 16.00 0% 0% 0.00
DHFSH13430 Installation of Timber Doors & Ironmongery 6.00 29-Apr-15 05-May-15 28-Jun-15 04-Jul-15 -50.00 0% 0% 0.00
DHFSH13802 Installation of Wardrobe 12.00 27-May-15 09-Jun-15 27-Jul-15 09-Aug-15 -50.00 0% 0% 0.00
DHFSH13500 Paint Final Coat 6.00 15-Jun-15 21-Jun-15 15-Aug-15 20-Aug-15 -38.00 0% 0% 0.00
Wet area 240.00 17-Jun-14 14-Jun-15 17-Jun-14 A 13-Aug-15 -50.00 28.8% 10.35% 0.36
DHFSH13110 Block Work in Wet Area 6.00 17-Jun-14 23-Jun-14 17-Jun-14 A 09-Jul-14 A 100% 100% 0.00
DHFSH13140 Marking,Cutting & Chasing - Wet Area 4.00 24-Jun-14 28-Jun-14 10-Jul-14 A 06-Aug-14 A 100% 100% 1.00
DHFSH13150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 29-Jun-14 02-Jul-14 14-Jul-14 A 07-Aug-14 A 100% 100% 1.00
DHMEP13170 Plaster in Wet Area 4.00 07-Jul-14 12-Jul-14 11-Aug-14 A 28-Aug-14 A 100% 100% 1.00
DHMEP13180 Wet Area Wall Tiling 6.00 24-Sep-14 01-Oct-14 02-Nov-14 08-Nov-14 1.00 85.42% 0% 0.00
DHFSH13300 Wet Area False Ceiling Suspension 5.00 01-Oct-14 09-Oct-14 22-Nov-14 26-Nov-14 4.00 0% 0% 0.00
DHFSH13370 Wet Area False Ceiling Tiling/Boarding 4.00 15-Nov-14 18-Nov-14 09-Dec-14 13-Dec-14 4.00 0% 0% 0.00
DHFSH13210 Wet Area Waterproofing 4.00 19-Nov-14 23-Nov-14 14-Dec-14 17-Dec-14 4.00 0% 0% 0.00
DHFSH13220 Wet Area Floor Screed 4.00 24-Nov-14 27-Nov-14 18-Dec-14 22-Dec-14 4.00 0% 0% 0.00
DHFSH13250 Wet Area Floor Tiling 5.00 29-Nov-14 04-Dec-14 23-Dec-14 28-Dec-14 4.00 0% 0% 0.00
DHFSH06570 Cabinet Carcass 5.00 15-Dec-14 20-Dec-14 05-Jan-15 10-Jan-15 -1.00 0% 0% 0.00
DHFSH13420 Installation of Shower Enclosure 4.00 06-May-15 10-May-15 05-Jul-15 08-Jul-15 -39.00 0% 0% 0.00
DHFSH13390 Installation of Vanity Counters & Tops 5.00 06-May-15 11-May-15 05-Jul-15 09-Jul-15 -50.00 0% 0% 0.00
DHFSH13800 Installation of Kitchen Cabinet 12.00 01-Jun-15 14-Jun-15 01-Aug-15 13-Aug-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 92.00 06-Aug-14 04-Apr-15 01-Sep-14 A 21-Jan-15 102.00 0% 0% 0.00
DHFSH13240 Corridor/Lift Lobby Floor Screed 4.00 06-Aug-14 11-Aug-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00
DHFSH13270 Lift Lobby Painting - Primer & Stucco 6.00 11-Aug-14 18-Aug-14 25-Sep-14 A 07-Oct-14 46.00 100% 35% 0.00
DHFSH13310 Lift Lobby False Ceiling Suspension 6.00 09-Oct-14 16-Oct-14 27-Nov-14 04-Dec-14 4.00 0% 0% 0.00
DHFSH13360 Lift Lobby False Ceiling Tiling / Boarding 5.00 15-Nov-14 19-Nov-14 09-Dec-14 14-Dec-14 101.00 0% 0% 0.00
DHFSH13410 Lift Lobby Painting - 1st Coat 6.00 20-Nov-14 26-Nov-14 15-Dec-14 21-Dec-14 101.00 0% 0% 0.00
DHFSH13440 Installation of Steel Doors & Windows 3.00 01-Apr-15 04-Apr-15 11-Jan-15 13-Jan-15 69.00 0% 0% 0.00
DHFSH13470 Lift Lobby Flooring 6.00 18-Dec-14 24-Dec-14 08-Jan-15 14-Jan-15 102.00 0% 0% 0.00
DHFSH13490 Utility Rooms- Epoxy Flooring 6.00 25-Dec-14 31-Dec-14 15-Jan-15 21-Jan-15 102.00 0% 0% 0.00
Staircase 92.00 27-Jul-14 12-Apr-15 01-Oct-14 21-Jan-15 83.00 45.08% 0% 0.00
DHFSH13200 Staircase Plastering 4.00 27-Jul-14 03-Aug-14 01-Oct-14 07-Oct-14 142.00 100% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Construction of Horizontals - L13
Construction of Verticals - L13
Stair # 2
Stair # 1
Dry Area Floor Screed
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 16 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH13280 Staircase Painting - Primer & Stucco 6.00 18-Aug-14 25-Aug-14 08-Oct-14 14-Oct-14 142.00 100% 0% 0.00
DHFSH13320 Staircase Handrail Fixing 3.00 29-Dec-14 03-Jan-15 10-Nov-14 12-Nov-14 131.00 0% 0% 0.00
DHFSH13330 Staircase Painting 1st Coat 3.00 03-Jan-15 06-Jan-15 21-Dec-14 23-Dec-14 100.00 0% 0% 0.00
DHFSH13340 Staircase Final Painting 5.00 05-Apr-15 09-Apr-15 14-Jan-15 19-Jan-15 83.00 0% 0% 0.00
DHFSH13380 Staircase Epoxy Flooring 2.00 11-Apr-15 12-Apr-15 20-Jan-15 21-Jan-15 83.00 0% 0% 0.00
General 293.00 25-May-14 15-Jul-15 07-Jun-14 A 09-Sep-15 -43.00 0% 0% 0.00
DHSTR13000 Access from Structure 0.00 25-May-14 07-Jun-14 A 100% 100% 0.00
DHFSH13510 Snagging & De-Snagging 12.00 02-Jul-15 15-Jul-15 27-Aug-15 09-Sep-15 -43.00 0% 0% 0.00
MEP - LEVEL 13 428.00 28-Apr-14 08-Jun-15 25-Apr-14 A 04-Aug-15 -44.00 69.07% 69.97% 1.01
DHMEP13000 Embeded Conduits & Boxex - Concrete Works 3.00 28-Apr-14 30-Apr-14 25-Apr-14 A 01-May-14 A 100% 100% 0.00
DHMEP13100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C26a-bMlianyg- ,1 4Wiring et1c6-Jun-14 07-Jun-14 A 06-Aug-14 A 100% 100% 1.00
DHMEP13130 Cable Trays & Cable Trunking 6.00 24-Jun-14 30-Jun-14 07-Jun-14 A 06-Aug-14 A 100% 100% 0.00
DHMEP13120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 29-Jun-14 05-Jul-14 13-Jul-14 A 08-Sep-14 A 100% 100% 1.00
DHMEP13160 Pressure Testing of Pipes 12.00 06-Jul-14 19-Jul-14 30-Jul-14 A 08-Oct-14 50.00 100% 63% 0.00
DHMEP13110 MEP Works in Risers& Clearance 5.00 20-Aug-14 25-Aug-14 15-Jun-14 A 18-Oct-14 -33.00 100% 69% 0.00
DHMEP13140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es08-Nov-14 13-Nov-14 13-Aug-14 A 08-Dec-14 4.00 0% 31% 0.00
DHMEP13150 MEP Final Fixes 6.00 18-May-15 24-May-15 15-Jul-15 23-Jul-15 -44.00 0% 0% 0.00
DHMEP06250 Sanitary ware /Toilet accessories 6.00 21-May-15 27-May-15 21-Jul-15 27-Jul-15 -44.00 0% 0% 0.00
DHMEP13200 Pre-Testing & Commissioning 7.00 01-Jun-15 08-Jun-15 28-Jul-15 04-Aug-15 -44.00 0% 0% 0.00
LEVEL 14 462.00 19-Apr-14 25-Jul-15 24-Feb-14 A 16-Sep-15 -43.00 69.77% 68.86% 0.99
STRUCTURAL WORKS - LEVEL 14 18.00 19-Apr-14 08-May-14 21-Apr-14 A 11-May-14 A 100% 100% 1.00
DHCWA15100 Core Wall - Level 14 4.00 19-Apr-14 22-Apr-14 21-Apr-14 A 27-Apr-14 A 100% 100% 1.00
DHSLA14100 Construction of Horizontals - L14 3.00 04-May-14 06-May-14 03-May-14 A 08-May-14 A 100% 100% 1.00
DHCWA15110 Construction of Verticals - L14 2.00 07-May-14 08-May-14 09-May-14 A 11-May-14 A 100% 100% 1.00
STAIRCASES 4.00 20-Jul-14 23-Jul-14 16-Jul-14 A 20-Jul-14 A 0% 0% 0.00
A1460 Stair # 1 4.00 20-Jul-14 23-Jul-14 16-Jul-14 A 20-Jul-14 A 100% 100% 0.00
A1470 Stair # 2 3.00 21-Jul-14 23-Jul-14 17-Jul-14 A 20-Jul-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 14 299.00 02-Jun-14 25-Jul-15 24-Feb-14 A 16-Sep-15 -43.00 25.16% 19.64% 0.78
Dry area 276.00 24-Jun-14 28-Jun-15 24-Feb-14 A 27-Aug-15 -38.00 35.99% 35.49% 0.99
DHMEP14190 Dry Area Floor Screed 7.00 03-Aug-14 11-Aug-14 24-Feb-14 A 24-Feb-14 A 100% 100% 0.00
DHFSH14100 Block Work in Dry Area 6.00 24-Jun-14 30-Jun-14 24-Jun-14 A 20-Jul-14 A 100% 100% 1.00
DHFSH14120 Marking,Cutting & Chasing - Dry Area 4.00 01-Jul-14 05-Jul-14 13-Jul-14 A 10-Aug-14 A 100% 100% 1.00
DHFSH14130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 06-Jul-14 09-Jul-14 10-Aug-14 A 12-Aug-14 A 100% 100% 1.00
DHFSH14160 Plaster in Dry Area 8.00 22-Jul-14 03-Aug-14 17-Aug-14 A 08-Sep-14 A 100% 100% 1.00
DHFSH14230 Dry Area Painting - Primer 4.00 11-Aug-14 16-Aug-14 25-Sep-14 A 02-Oct-14 83.00 100% 50% 0.00
DHFSH14260 Dry Area Painting - Stucco 6.00 16-Aug-14 23-Aug-14 06-Oct-14 12-Oct-14 83.00 100% 0% 0.00
DHFSH14290 Dry Area False Ceiling Suspension 6.00 29-Sep-14 08-Oct-14 19-Nov-14 25-Nov-14 -15.00 18.75% 0% 0.00
DHFSH14350 Dry Area False Ceiling Tiling / Boarding 5.00 18-Nov-14 23-Nov-14 14-Dec-14 18-Dec-14 27.00 0% 0% 0.00
DHFSH14400 Dry Area Painting - 1st Coat 5.00 24-Nov-14 29-Nov-14 20-Dec-14 24-Dec-14 27.00 0% 0% 0.00
DHFSH14450 Dry Area Flooring 5.00 18-Dec-14 23-Dec-14 08-Jan-15 13-Jan-15 16.00 0% 0% 0.00
DHFSH14430 Installation of Timber Doors & Ironmongery 5.00 06-May-15 11-May-15 05-Jul-15 09-Jul-15 -50.00 0% 0% 0.00
DHFSH14802 Installation of Wardrobe 12.00 03-Jun-15 16-Jun-15 03-Aug-15 16-Aug-15 -50.00 0% 0% 0.00
DHFSH14500 Paint Final Coat 6.00 22-Jun-15 28-Jun-15 22-Aug-15 27-Aug-15 -38.00 0% 0% 0.00
Wet area 242.00 24-Jun-14 21-Jun-15 24-Jun-14 A 20-Aug-15 -50.00 14.4% 10.35% 0.72
DHFSH14110 Block Work in Wet Area 6.00 24-Jun-14 30-Jun-14 24-Jun-14 A 20-Jul-14 A 100% 100% 0.00
DHFSH14140 Marking,Cutting & Chasing - Wet Area 4.00 01-Jul-14 05-Jul-14 13-Jul-14 A 10-Aug-14 A 100% 100% 1.00
DHFSH14150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 06-Jul-14 09-Jul-14 10-Aug-14 A 12-Aug-14 A 100% 100% 1.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - Level 14
Construction of Horizontals - L14
Construction of Verticals - L14
Stair # 1
Stair # 2
Dry Area Floor Screed
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 17 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
DAMAC Gulf Properties L.L.C
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHMEP14170 Plaster in Wet Area 4.00 13-Jul-14 16-Jul-14 17-Aug-14 A 08-Sep-14 A 100% 100% 1.00
DHMEP14180 Wet Area Wall Tiling 6.00 29-Sep-14 08-Oct-14 06-Nov-14 12-Nov-14 1.00 18.75% 0% 0.00
DHFSH14300 Wet Area False Ceiling Suspension 5.00 08-Oct-14 14-Oct-14 26-Nov-14 01-Dec-14 5.00 0% 0% 0.00
DHFSH14370 Wet Area False Ceiling Tiling/Boarding 4.00 18-Nov-14 22-Nov-14 14-Dec-14 17-Dec-14 5.00 0% 0% 0.00
DHFSH14210 Wet Area Waterproofing 4.00 23-Nov-14 26-Nov-14 18-Dec-14 22-Dec-14 5.00 0% 0% 0.00
DHFSH14220 Wet Area Floor Screed 4.00 27-Nov-14 01-Dec-14 23-Dec-14 27-Dec-14 5.00 0% 0% 0.00
DHFSH14250 Wet Area Floor Tiling 5.00 03-Dec-14 08-Dec-14 28-Dec-14 03-Jan-15 5.00 0% 0% 0.00
DHFSH06580 Cabinet Carcass 5.00 21-Dec-14 25-Dec-14 11-Jan-15 15-Jan-15 -1.00 0% 0% 0.00
DHFSH14420 Installation of Shower Enclosure 4.00 11-May-15 14-May-15 09-Jul-15 13-Jul-15 -37.00 0% 0% 0.00
DHFSH14390 Installation of Vanity Counters & Tops 5.00 12-May-15 18-May-15 11-Jul-15 15-Jul-15 -50.00 0% 0% 0.00
DHFSH14800 Installation of Kitchen Cabinet 12.00 08-Jun-15 21-Jun-15 08-Aug-15 20-Aug-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 97.00 11-Aug-14 07-Apr-15 01-Sep-14 A 27-Jan-15 99.00 0% 0% 0.00
DHFSH14240 Corridor/Lift Lobby Floor Screed 4.00 11-Aug-14 16-Aug-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00
DHFSH14270 Lift Lobby Painting - Primer & Stucco 6.00 16-Aug-14 23-Aug-14 25-Sep-14 A 08-Oct-14 50.00 100% 15% 0.00
DHFSH14310 Lift Lobby False Ceiling Suspension 6.00 14-Oct-14 21-Oct-14 03-Dec-14 09-Dec-14 5.00 0% 0% 0.00
DHFSH14360 Lift Lobby False Ceiling Tiling / Boarding 5.00 18-Nov-14 23-Nov-14 14-Dec-14 18-Dec-14 100.00 0% 0% 0.00
DHFSH14410 Lift Lobby Painting - 1st Coat 6.00 24-Nov-14 30-Nov-14 20-Dec-14 25-Dec-14 100.00 0% 0% 0.00
DHFSH14440 Installation of Steel Doors & Windows 3.00 05-Apr-15 07-Apr-15 17-Jan-15 19-Jan-15 67.00 0% 0% 0.00
DHFSH14470 Lift Lobby Flooring 6.00 24-Dec-14 30-Dec-14 14-Jan-15 20-Jan-15 99.00 0% 0% 0.00
DHFSH14490 Utility Rooms- Epoxy Flooring 6.00 31-Dec-14 07-Jan-15 21-Jan-15 27-Jan-15 99.00 0% 0% 0.00
Staircase 97.00 03-Aug-14 15-Apr-15 01-Oct-14 27-Jan-15 84.00 45.08% 0% 0.00
DHFSH14200 Staircase Plastering 4.00 03-Aug-14 07-Aug-14 01-Oct-14 07-Oct-14 92.00 100% 0% 0.00
DHFSH14280 Staircase Painting - Primer & Stucco 6.00 23-Aug-14 30-Aug-14 09-Oct-14 15-Oct-14 144.00 100% 0% 0.00
DHFSH14320 Staircase Handrail Fixing 3.00 03-Jan-15 06-Jan-15 13-Nov-14 16-Nov-14 134.00 0% 0% 0.00
DHFSH14330 Staircase Painting 1st Coat 3.00 06-Jan-15 10-Jan-15 25-Dec-14 28-Dec-14 102.00 0% 0% 0.00
DHFSH14340 Staircase Final Painting 5.00 08-Apr-15 13-Apr-15 20-Jan-15 25-Jan-15 84.00 0% 0% 0.00
DHFSH14380 Staircase Epoxy Flooring 2.00 14-Apr-15 15-Apr-15 26-Jan-15 27-Jan-15 84.00 0% 0% 0.00
General 299.00 02-Jun-14 25-Jul-15 12-Jun-14 A 16-Sep-15 -43.00 0% 0% 0.00
DHSTR14000 Access from Structure 0.00 02-Jun-14 12-Jun-14 A 100% 100% 0.00
DHFSH14510 Snagging & De-Snagging 12.00 09-Jul-15 25-Jul-15 03-Sep-15 16-Sep-15 -43.00 0% 0% 0.00
MEP - LEVEL 14 431.00 04-May-14 15-Jun-15 03-May-14 A 11-Aug-15 -44.00 69.07% 69.97% 1.01
DHMEP14000 Embeded Conduits & Boxex - Concrete Works 3.00 04-May-14 06-May-14 03-May-14 A 08-May-14 A 100% 100% 0.00
DHMEP14100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C02a-bJluinng-1 ,4 Wiring et2c2-Jun-14 12-Jun-14 A 05-Aug-14 A 100% 100% 1.00
DHMEP14130 Cable Trays & Cable Trunking 6.00 01-Jul-14 07-Jul-14 12-Jun-14 A 05-Aug-14 A 100% 100% 0.00
DHMEP14160 Pressure Testing of Pipes 12.00 13-Jul-14 26-Jul-14 30-Jul-14 A 12-Aug-14 A 100% 100% 0.00
DHMEP14120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 06-Jul-14 12-Jul-14 22-Jul-14 A 08-Sep-14 A 100% 100% 1.00
DHMEP14110 MEP Works in Risers& Clearance 5.00 26-Aug-14 31-Aug-14 14-Jul-14 A 23-Oct-14 -33.00 100% 69% 0.00
DHMEP14140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es11-Nov-14 17-Nov-14 16-Aug-14 A 13-Dec-14 5.00 0% 31% 0.00
DHMEP14150 MEP Final Fixes 6.00 23-May-15 28-May-15 22-Jul-15 28-Jul-15 -42.00 0% 0% 0.00
DHMEP06260 Sanitary ware /Toilet accessories 6.00 26-May-15 01-Jun-15 26-Jul-15 01-Aug-15 -42.00 0% 0% 0.00
DHMEP14200 Pre-Testing & Commissioning 7.00 08-Jun-15 15-Jun-15 04-Aug-15 11-Aug-15 -44.00 0% 0% 0.00
LEVEL 15 465.00 23-Apr-14 01-Aug-15 28-Apr-14 A 26-Sep-15 -43.00 69.31% 68.9% 0.99
STRUCTURAL WORKS -LEVEL 15 19.00 23-Apr-14 14-May-14 28-Apr-14 A 18-May-14 A 100% 100% 1.00
DHCWA16100 Core Wall - Level 15 9.00 23-Apr-14 03-May-14 28-Apr-14 A 05-May-14 A 100% 100% 1.00
DHSLA15100 Construction of Horizontals - L15 3.00 10-May-14 12-May-14 10-May-14 A 15-May-14 A 100% 100% 1.00
DHCWA16110 Construction of Verticals - L15 2.00 13-May-14 14-May-14 17-May-14 A 18-May-14 A 100% 100% 1.00
STAIRCASES 4.00 27-Jul-14 02-Aug-14 22-Jul-14 A 26-Jul-14 A 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Pressure Testing of Pipes
Embeded Condiuts,Boxes and Sleeves in Walls
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - Level 15
Construction of Horizontals - L15
Construction of Verticals - L15
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 18 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
A1480 Stair # 1 4.00 27-Jul-14 02-Aug-14 22-Jul-14 A 26-Jul-14 A 100% 100% 0.00
A1490 Stair # 2 3.00 30-Jul-14 02-Aug-14 22-Jul-14 A 26-Jul-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 15 305.00 08-Jun-14 01-Aug-15 19-Jun-14 A 26-Sep-15 -43.00 23.05% 19.64% 0.85
Dry area 282.00 29-Jun-14 05-Jul-15 02-Jul-14 A 03-Sep-15 -38.00 35.49% 35.49% 1.00
DHFSH15100 Block Work in Dry Area 6.00 29-Jun-14 05-Jul-14 02-Jul-14 A 20-Jul-14 A 100% 100% 1.00
DHFSH15120 Marking,Cutting & Chasing - Dry Area 4.00 06-Jul-14 09-Jul-14 09-Aug-14 A 12-Aug-14 A 100% 100% 1.00
DHFSH15130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 10-Jul-14 14-Jul-14 11-Aug-14 A 17-Aug-14 A 100% 100% 1.00
DHFSH15160 Plaster in Dry Area 8.00 27-Jul-14 07-Aug-14 17-Aug-14 A 13-Sep-14 A 100% 100% 1.00
DHMEP15190 Dry Area Floor Screed 7.00 07-Aug-14 16-Aug-14 01-Oct-14 11-Oct-14 42.00 100% 0% 0.00
DHFSH15230 Dry Area Painting - Primer 4.00 16-Aug-14 20-Aug-14 12-Oct-14 15-Oct-14 79.00 100% 0% 0.00
DHFSH15260 Dry Area Painting - Stucco 6.00 20-Aug-14 27-Aug-14 16-Oct-14 22-Oct-14 79.00 100% 0% 0.00
DHFSH15290 Dry Area False Ceiling Suspension 6.00 06-Oct-14 13-Oct-14 24-Nov-14 30-Nov-14 -15.00 0% 0% 0.00
DHFSH15350 Dry Area False Ceiling Tiling / Boarding 5.00 22-Nov-14 26-Nov-14 18-Dec-14 23-Dec-14 28.00 0% 0% 0.00
DHFSH15400 Dry Area Painting - 1st Coat 5.00 27-Nov-14 03-Dec-14 24-Dec-14 29-Dec-14 28.00 0% 0% 0.00
DHFSH15450 Dry Area Flooring 5.00 24-Dec-14 29-Dec-14 14-Jan-15 19-Jan-15 16.00 0% 0% 0.00
DHFSH15430 Installation of Timber Doors & Ironmongery 5.00 12-May-15 18-May-15 11-Jul-15 15-Jul-15 -50.00 0% 0% 0.00
DHFSH15802 Installation of Wardrobe 12.00 08-Jun-15 21-Jun-15 08-Aug-15 20-Aug-15 -50.00 0% 0% 0.00
DHFSH15500 Paint Final Coat 6.00 29-Jun-15 05-Jul-15 29-Aug-15 03-Sep-15 -38.00 0% 0% 0.00
Wet area 244.00 29-Jun-14 28-Jun-15 02-Jul-14 A 27-Aug-15 -50.00 10.35% 10.35% 1.00
DHFSH15110 Block Work in Wet Area 6.00 29-Jun-14 05-Jul-14 02-Jul-14 A 20-Jul-14 A 100% 100% 0.00
DHFSH15140 Marking,Cutting & Chasing - Wet Area 4.00 06-Jul-14 09-Jul-14 09-Aug-14 A 12-Aug-14 A 100% 100% 1.00
DHFSH15150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 10-Jul-14 14-Jul-14 11-Aug-14 A 17-Aug-14 A 100% 100% 1.00
DHMEP15170 Plaster in Wet Area 4.00 17-Jul-14 21-Jul-14 17-Aug-14 A 13-Sep-14 A 100% 100% 1.00
DHMEP15180 Wet Area Wall Tiling 6.00 06-Oct-14 13-Oct-14 11-Nov-14 17-Nov-14 1.00 0% 0% 0.00
DHFSH15300 Wet Area False Ceiling Suspension 5.00 13-Oct-14 19-Oct-14 01-Dec-14 07-Dec-14 5.00 0% 0% 0.00
DHFSH15370 Wet Area False Ceiling Tiling/Boarding 4.00 22-Nov-14 25-Nov-14 18-Dec-14 22-Dec-14 6.00 0% 0% 0.00
DHFSH15210 Wet Area Waterproofing 4.00 26-Nov-14 30-Nov-14 23-Dec-14 27-Dec-14 6.00 0% 0% 0.00
DHFSH15220 Wet Area Floor Screed 4.00 01-Dec-14 06-Dec-14 28-Dec-14 31-Dec-14 6.00 0% 0% 0.00
DHFSH15250 Wet Area Floor Tiling 5.00 07-Dec-14 11-Dec-14 03-Jan-15 07-Jan-15 6.00 0% 0% 0.00
DHFSH06590 Cabinet Carcass 5.00 27-Dec-14 31-Dec-14 17-Jan-15 21-Jan-15 -1.00 0% 0% 0.00
DHFSH15420 Installation of Shower Enclosure 4.00 18-May-15 21-May-15 15-Jul-15 21-Jul-15 -36.00 0% 0% 0.00
DHFSH15390 Installation of Vanity Counters & Tops 5.00 20-May-15 25-May-15 20-Jul-15 25-Jul-15 -50.00 0% 0% 0.00
DHFSH15800 Installation of Kitchen Cabinet 12.00 15-Jun-15 28-Jun-15 15-Aug-15 27-Aug-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 95.00 16-Aug-14 11-Apr-15 12-Oct-14 02-Feb-15 96.00 0% 0% 0.00
DHFSH15240 Corridor/Lift Lobby Floor Screed 4.00 16-Aug-14 20-Aug-14 12-Oct-14 15-Oct-14 42.00 100% 0% 0.00
DHFSH15270 Lift Lobby Painting - Primer & Stucco 6.00 20-Aug-14 27-Aug-14 16-Oct-14 22-Oct-14 42.00 100% 0% 0.00
DHFSH15310 Lift Lobby False Ceiling Suspension 6.00 19-Oct-14 27-Oct-14 08-Dec-14 14-Dec-14 5.00 0% 0% 0.00
DHFSH15360 Lift Lobby False Ceiling Tiling / Boarding 5.00 22-Nov-14 26-Nov-14 18-Dec-14 23-Dec-14 99.00 0% 0% 0.00
DHFSH15410 Lift Lobby Painting - 1st Coat 6.00 27-Nov-14 04-Dec-14 24-Dec-14 30-Dec-14 99.00 0% 0% 0.00
DHFSH15440 Installation of Steel Doors & Windows 3.00 08-Apr-15 11-Apr-15 22-Jan-15 25-Jan-15 65.00 0% 0% 0.00
DHFSH15470 Lift Lobby Flooring 6.00 30-Dec-14 06-Jan-15 20-Jan-15 26-Jan-15 96.00 0% 0% 0.00
DHFSH15490 Utility Rooms- Epoxy Flooring 6.00 07-Jan-15 13-Jan-15 27-Jan-15 02-Feb-15 96.00 0% 0% 0.00
Staircase 102.00 07-Aug-14 19-Apr-15 01-Oct-14 02-Feb-15 84.00 45.08% 0% 0.00
DHFSH15200 Staircase Plastering 4.00 07-Aug-14 12-Aug-14 01-Oct-14 07-Oct-14 148.00 100% 0% 0.00
DHFSH15280 Staircase Painting - Primer & Stucco 6.00 27-Aug-14 03-Sep-14 23-Oct-14 30-Oct-14 135.00 100% 0% 0.00
DHFSH15320 Staircase Handrail Fixing 3.00 06-Jan-15 10-Jan-15 17-Nov-14 19-Nov-14 136.00 0% 0% 0.00
DHFSH15330 Staircase Painting 1st Coat 3.00 10-Jan-15 13-Jan-15 30-Dec-14 03-Jan-15 103.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 19 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH15340 Staircase Final Painting 5.00 12-Apr-15 16-Apr-15 26-Jan-15 31-Jan-15 84.00 0% 0% 0.00
DHFSH15380 Staircase Epoxy Flooring 2.00 18-Apr-15 19-Apr-15 01-Feb-15 02-Feb-15 84.00 0% 0% 0.00
General 305.00 08-Jun-14 01-Aug-15 19-Jun-14 A 26-Sep-15 -43.00 0% 0% 0.00
DHSTR15000 Access from Structure 0.00 08-Jun-14 19-Jun-14 A 100% 100% 0.00
DHFSH15510 Snagging & De-Snagging 12.00 16-Jul-15 01-Aug-15 10-Sep-15 26-Sep-15 -43.00 0% 0% 0.00
MEP - LEVEL 15 434.00 10-May-14 22-Jun-15 10-May-14 A 18-Aug-15 -44.00 69.07% 69.97% 1.01
DHMEP15000 Embeded Conduits & Boxex - Concrete Works 3.00 10-May-14 12-May-14 10-May-14 A 15-May-14 A 100% 100% 0.00
DHMEP15100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C08a-bJluinng-1 ,4 Wiring et2c8-Jun-14 19-Jun-14 A 04-Aug-14 A 100% 100% 1.00
DHMEP15130 Cable Trays & Cable Trunking 6.00 06-Jul-14 12-Jul-14 19-Jun-14 A 04-Aug-14 A 100% 100% 0.00
DHMEP15160 Pressure Testing of Pipes 12.00 17-Jul-14 02-Aug-14 15-Jul-14 A 19-Aug-14 A 100% 100% 0.00
DHMEP15120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 10-Jul-14 16-Jul-14 04-Aug-14 A 10-Sep-14 A 100% 100% 1.00
DHMEP15110 MEP Works in Risers& Clearance 5.00 01-Sep-14 06-Sep-14 14-Jul-14 A 30-Oct-14 -33.00 100% 69% 0.00
DHMEP15140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es15-Nov-14 20-Nov-14 18-Aug-14 A 17-Dec-14 5.00 0% 31% 0.00
DHMEP15150 MEP Final Fixes 6.00 27-May-15 02-Jun-15 27-Jul-15 02-Aug-15 -40.00 0% 0% 0.00
DHMEP06270 Sanitary ware /Toilet accessories 6.00 31-May-15 06-Jun-15 30-Jul-15 05-Aug-15 -40.00 0% 0% 0.00
DHMEP15200 Pre-Testing & Commissioning 7.00 15-Jun-15 22-Jun-15 11-Aug-15 18-Aug-15 -44.00 0% 0% 0.00
LEVEL 16 496.00 04-May-14 08-Aug-15 05-May-14 A 22-Oct-15 -59.00 69.38% 68.9% 0.99
STRUCTURAL WORKS -LEVEL 16 121.00 04-May-14 20-May-14 05-May-14 A 23-May-14 A 100% 100% 1.00
DHCWA17120 Tower Crane Jump 1.00 08-May-14 08-May-14 05-May-14 A 05-May-14 A 100% 100% 0.00
DHCWA17100 Core Wall - Level 16 5.00 04-May-14 08-May-14 06-May-14 A 08-May-14 A 100% 100% 1.00
DHSLA16100 Construction of Horizontals- L16 3.00 15-May-14 18-May-14 16-May-14 A 20-May-14 A 100% 100% 1.00
DHCWA17110 Construction of Verticals - L16 2.00 19-May-14 20-May-14 21-May-14 A 23-May-14 A 100% 100% 1.00
STAIRCASES 4.00 04-Aug-14 07-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0% 0.00
A1500 Stair # 1 4.00 04-Aug-14 07-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00
A1510 Stair # 2 3.00 05-Aug-14 07-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 16 311.00 14-Jun-14 08-Aug-15 26-Jun-14 A 03-Oct-15 -43.00 23.05% 19.64% 0.85
Dry area 288.00 05-Jul-14 12-Jul-15 07-Jul-14 A 10-Sep-15 -38.00 35.49% 35.49% 1.00
DHFSH16100 Block Work in Dry Area 6.00 05-Jul-14 10-Jul-14 07-Jul-14 A 28-Jul-14 A 100% 100% 1.00
DHFSH16120 Marking,Cutting & Chasing - Dry Area 4.00 12-Jul-14 15-Jul-14 12-Aug-14 A 14-Aug-14 A 100% 100% 1.00
DHFSH16130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 16-Jul-14 20-Jul-14 18-Aug-14 A 26-Aug-14 A 100% 100% 1.00
DHFSH16160 Plaster in Dry Area 8.00 03-Aug-14 12-Aug-14 20-Aug-14 A 18-Sep-14 A 100% 100% 1.00
DHMEP16190 Dry Area Floor Screed 7.00 12-Aug-14 20-Aug-14 01-Oct-14 11-Oct-14 45.00 100% 0% 0.00
DHFSH16230 Dry Area Painting - Primer 4.00 20-Aug-14 25-Aug-14 12-Oct-14 15-Oct-14 84.00 100% 0% 0.00
DHFSH16260 Dry Area Painting - Stucco 6.00 25-Aug-14 01-Sep-14 16-Oct-14 22-Oct-14 84.00 100% 0% 0.00
DHFSH16290 Dry Area False Ceiling Suspension 6.00 11-Oct-14 18-Oct-14 29-Nov-14 06-Dec-14 -15.00 0% 0% 0.00
DHFSH16350 Dry Area False Ceiling Tiling / Boarding 5.00 25-Nov-14 30-Nov-14 23-Dec-14 28-Dec-14 29.00 0% 0% 0.00
DHFSH16400 Dry Area Painting - 1st Coat 5.00 01-Dec-14 07-Dec-14 29-Dec-14 04-Jan-15 29.00 0% 0% 0.00
DHFSH16450 Dry Area Flooring 5.00 30-Dec-14 05-Jan-15 20-Jan-15 25-Jan-15 16.00 0% 0% 0.00
DHFSH16430 Installation of Timber Doors & Ironmongery 5.00 18-May-15 23-May-15 15-Jul-15 22-Jul-15 -50.00 0% 0% 0.00
DHFSH16802 Installation of Wardrobe 12.00 15-Jun-15 28-Jun-15 15-Aug-15 27-Aug-15 -50.00 0% 0% 0.00
DHFSH16500 Paint Final Coat 6.00 06-Jul-15 12-Jul-15 05-Sep-15 10-Sep-15 -38.00 0% 0% 0.00
Wet area 246.00 05-Jul-14 05-Jul-15 07-Jul-14 A 03-Sep-15 -50.00 10.35% 10.35% 1.00
DHFSH16110 Block Work in Wet Area 6.00 05-Jul-14 10-Jul-14 07-Jul-14 A 28-Jul-14 A 100% 100% 0.00
DHFSH16140 Marking,Cutting & Chasing - Wet Area 4.00 12-Jul-14 15-Jul-14 12-Aug-14 A 14-Aug-14 A 100% 100% 1.00
DHFSH16150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 16-Jul-14 20-Jul-14 18-Aug-14 A 26-Aug-14 A 100% 100% 1.00
DHMEP16170 Plaster in Wet Area 4.00 23-Jul-14 27-Jul-14 20-Aug-14 A 18-Sep-14 A 100% 100% 1.00
DHMEP16180 Wet Area Wall Tiling 6.00 11-Oct-14 18-Oct-14 16-Nov-14 22-Nov-14 1.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Pressure Testing of Pipes
Embeded Condiuts,Boxes and Sleeves in Walls
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Tower Crane Jump
Core Wall - Level 16
Construction of Horizontals- L16
Construction of Verticals - L16
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 20 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH16300 Wet Area False Ceiling Suspension 5.00 18-Oct-14 23-Oct-14 07-Dec-14 11-Dec-14 4.00 0% 0% 0.00
DHFSH16370 Wet Area False Ceiling Tiling/Boarding 4.00 25-Nov-14 29-Nov-14 23-Dec-14 27-Dec-14 6.00 0% 0% 0.00
DHFSH16210 Wet Area Waterproofing 4.00 30-Nov-14 04-Dec-14 28-Dec-14 31-Dec-14 6.00 0% 0% 0.00
DHFSH16220 Wet Area Floor Screed 4.00 06-Dec-14 09-Dec-14 03-Jan-15 06-Jan-15 6.00 0% 0% 0.00
DHFSH16250 Wet Area Floor Tiling 6.00 10-Dec-14 16-Dec-14 07-Jan-15 13-Jan-15 6.00 0% 0% 0.00
DHFSH06600 Cabinet Carcass 5.00 03-Jan-15 07-Jan-15 22-Jan-15 27-Jan-15 -1.00 0% 0% 0.00
DHFSH16420 Installation of Shower Enclosure 4.00 23-May-15 26-May-15 22-Jul-15 26-Jul-15 -37.00 0% 0% 0.00
DHFSH16390 Installation of Vanity Counters & Tops 5.00 25-May-15 30-May-15 25-Jul-15 29-Jul-15 -50.00 0% 0% 0.00
DHFSH16800 Installation of Kitchen Cabinet 12.00 22-Jun-15 05-Jul-15 22-Aug-15 03-Sep-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 100.00 20-Aug-14 14-Apr-15 12-Oct-14 08-Feb-15 93.00 0% 0% 0.00
DHFSH16240 Corridor/Lift Lobby Floor Screed 4.00 20-Aug-14 25-Aug-14 12-Oct-14 15-Oct-14 45.00 100% 0% 0.00
DHFSH16270 Lift Lobby Painting - Primer & Stucco 6.00 25-Aug-14 01-Sep-14 16-Oct-14 22-Oct-14 45.00 100% 0% 0.00
DHFSH16310 Lift Lobby False Ceiling Suspension 6.00 23-Oct-14 01-Nov-14 13-Dec-14 18-Dec-14 4.00 0% 0% 0.00
DHFSH16360 Lift Lobby False Ceiling Tiling / Boarding 5.00 25-Nov-14 30-Nov-14 23-Dec-14 28-Dec-14 98.00 0% 0% 0.00
DHFSH16410 Lift Lobby Painting - 1st Coat 6.00 01-Dec-14 08-Dec-14 29-Dec-14 05-Jan-15 98.00 0% 0% 0.00
DHFSH16440 Installation of Steel Doors & Windows 3.00 12-Apr-15 14-Apr-15 28-Jan-15 31-Jan-15 63.00 0% 0% 0.00
DHFSH16470 Lift Lobby Flooring 6.00 06-Jan-15 12-Jan-15 26-Jan-15 01-Feb-15 93.00 0% 0% 0.00
DHFSH16490 Utility Rooms- Epoxy Flooring 6.00 13-Jan-15 19-Jan-15 02-Feb-15 08-Feb-15 93.00 0% 0% 0.00
Staircase 107.00 12-Aug-14 22-Apr-15 01-Oct-14 08-Feb-15 83.00 45.08% 0% 0.00
DHFSH16200 Staircase Plastering 4.00 12-Aug-14 17-Aug-14 01-Oct-14 07-Oct-14 151.00 100% 0% 0.00
DHFSH16280 Staircase Painting - Primer & Stucco 6.00 01-Sep-14 08-Sep-14 23-Oct-14 30-Oct-14 138.00 100% 0% 0.00
DHFSH16320 Staircase Handrail Fixing 3.00 10-Jan-15 13-Jan-15 20-Nov-14 23-Nov-14 137.00 0% 0% 0.00
DHFSH16330 Staircase Painting 1st Coat 3.00 13-Jan-15 17-Jan-15 05-Jan-15 07-Jan-15 103.00 0% 0% 0.00
DHFSH16340 Staircase Final Painting 5.00 15-Apr-15 20-Apr-15 01-Feb-15 05-Feb-15 83.00 0% 0% 0.00
DHFSH16380 Staircase Epoxy Flooring 2.00 21-Apr-15 22-Apr-15 07-Feb-15 08-Feb-15 83.00 0% 0% 0.00
General 311.00 14-Jun-14 08-Aug-15 26-Jun-14 A 03-Oct-15 -43.00 0% 0% 0.00
DHSTR16000 Access from Structure 0.00 14-Jun-14 26-Jun-14 A 100% 100% 0.00
DHFSH16510 Snagging & De-Snagging 12.00 26-Jul-15 08-Aug-15 17-Sep-15 03-Oct-15 -43.00 0% 0% 0.00
MEP - LEVEL 16 496.00 15-May-14 29-Jun-15 16-May-14 A 22-Oct-15 -91.00 69.07% 69.82% 1.01
DHMEP16000 Embeded Conduits & Boxex - Concrete Works 3.00 15-May-14 18-May-14 16-May-14 A 20-May-14 A 100% 100% 0.00
DHMEP16100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C14a-bJluinng-1 ,4 Wiring et0c3-Jul-14 26-Jun-14 A 12-Aug-14 A 100% 100% 1.00
DHMEP16130 Cable Trays & Cable Trunking 6.00 12-Jul-14 17-Jul-14 26-Jun-14 A 12-Aug-14 A 100% 100% 0.00
DHMEP16160 Pressure Testing of Pipes 12.00 23-Jul-14 07-Aug-14 02-Aug-14 A 20-Aug-14 A 100% 100% 0.00
DHMEP16120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 16-Jul-14 22-Jul-14 04-Aug-14 A 15-Sep-14 A 100% 100% 1.00
DHMEP16110 MEP Works in Risers& Clearance 5.00 07-Sep-14 11-Sep-14 24-Jul-14 A 05-Nov-14 -33.00 100% 69% 0.00
DHMEP16140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es18-Nov-14 24-Nov-14 20-Aug-14 A 22-Dec-14 4.00 0% 26% 0.00
DHMEP16150 MEP Final Fixes 6.00 01-Jun-15 07-Jun-15 01-Aug-15 06-Aug-15 -40.00 0% 0% 0.00
DHMEP06280 Sanitary ware /Toilet accessories 6.00 04-Jun-15 10-Jun-15 04-Aug-15 10-Aug-15 -38.00 0% 0% 0.00
DHMEP16200 Pre-Testing & Commissioning 7.00 22-Jun-15 29-Jun-15 18-Aug-15 25-Aug-15 -44.00 0% 0% 0.00
DHMEP16010 Busbar - L16 to L20 20.00 05-Apr-15 27-Apr-15 29-Sep-15 22-Oct-15 -144.00 0% 0% 0.00
LEVEL 17 483.00 10-May-14 15-Aug-15 10-May-14 A 10-Oct-15 -43.00 69.41% 68.99% 0.99
STRUCTURAL WORKS - LEVEL 17 15.00 10-May-14 26-May-14 10-May-14 A 30-May-14 A 100% 100% 1.00
DHCWA18100 Core Wall - Level 17 5.00 10-May-14 14-May-14 10-May-14 A 14-May-14 A 100% 100% 1.00
DHSLA17100 Construction of Horizontals - L17 3.00 21-May-14 24-May-14 21-May-14 A 27-May-14 A 100% 100% 1.00
DHCWA18110 Construction of Verticals - L17 2.00 25-May-14 26-May-14 28-May-14 A 30-May-14 A 100% 100% 1.00
STAIRCASES 4.00 10-Aug-14 13-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0% 0.00
A1520 Stair # 1 4.00 10-Aug-14 13-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Pressure Testing of Pipes
Embeded Condiuts,Boxes and Sleeves in Walls
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Busbar - L16 to L20
Core Wall - Level 17
Construction of Horizontals - L17
Construction of Verticals - L17
Stair # 1
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 21 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
A1530 Stair # 2 3.00 11-Aug-14 13-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 17 317.00 30-Jun-14 15-Aug-15 01-Jul-14 A 10-Oct-15 -43.00 23.05% 19.64% 0.85
Dry area 294.00 21-Jul-14 21-Jul-15 10-Jul-14 A 17-Sep-15 -38.00 35.49% 35.49% 1.00
DHFSH17100 Block Work in Dry Area 6.00 21-Jul-14 27-Jul-14 10-Jul-14 A 12-Aug-14 A 100% 100% 1.00
DHFSH17120 Marking,Cutting & Chasing - Dry Area 4.00 30-Jul-14 03-Aug-14 14-Aug-14 A 17-Aug-14 A 100% 100% 1.00
DHFSH17130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 04-Aug-14 07-Aug-14 28-Aug-14 A 02-Sep-14 A 100% 100% 1.00
DHFSH17160 Plaster in Dry Area 8.00 11-Aug-14 19-Aug-14 30-Aug-14 A 22-Sep-14 A 100% 100% 1.00
DHMEP17190 Dry Area Floor Screed 7.00 20-Aug-14 27-Aug-14 01-Oct-14 11-Oct-14 48.00 100% 0% 0.00
DHFSH17230 Dry Area Painting - Primer 4.00 28-Aug-14 01-Sep-14 12-Oct-14 15-Oct-14 89.00 100% 0% 0.00
DHFSH17260 Dry Area Painting - Stucco 6.00 02-Sep-14 08-Sep-14 16-Oct-14 22-Oct-14 89.00 100% 0% 0.00
DHFSH17290 Dry Area False Ceiling Suspension 6.00 15-Oct-14 22-Oct-14 04-Dec-14 10-Dec-14 -15.00 0% 0% 0.00
DHFSH17350 Dry Area False Ceiling Tiling / Boarding 5.00 29-Nov-14 04-Dec-14 28-Dec-14 03-Jan-15 30.00 0% 0% 0.00
DHFSH17400 Dry Area Painting - 1st Coat 5.00 06-Dec-14 10-Dec-14 04-Jan-15 08-Jan-15 30.00 0% 0% 0.00
DHFSH17450 Dry Area Flooring 5.00 06-Jan-15 11-Jan-15 26-Jan-15 31-Jan-15 16.00 0% 0% 0.00
DHFSH17430 Installation of Timber Doors & Ironmongery 5.00 23-May-15 27-May-15 22-Jul-15 27-Jul-15 -50.00 0% 0% 0.00
DHFSH17802 Installation of Wardrobe 12.00 22-Jun-15 05-Jul-15 22-Aug-15 03-Sep-15 -50.00 0% 0% 0.00
DHFSH17500 Paint Final Coat 6.00 13-Jul-15 21-Jul-15 12-Sep-15 17-Sep-15 -38.00 0% 0% 0.00
Wet area 248.00 21-Jul-14 12-Jul-15 10-Jul-14 A 10-Sep-15 -50.00 10.35% 10.35% 1.00
DHFSH17110 Block Work in Wet Area 6.00 21-Jul-14 27-Jul-14 10-Jul-14 A 12-Aug-14 A 100% 100% 0.00
DHFSH17140 Marking,Cutting & Chasing - Wet Area 4.00 30-Jul-14 03-Aug-14 14-Aug-14 A 17-Aug-14 A 100% 100% 1.00
DHFSH17150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 04-Aug-14 07-Aug-14 28-Aug-14 A 02-Sep-14 A 100% 100% 1.00
DHMEP17170 Plaster in Wet Area 4.00 11-Aug-14 14-Aug-14 30-Aug-14 A 22-Sep-14 A 100% 100% 1.00
DHMEP17180 Wet Area Wall Tiling 6.00 15-Oct-14 22-Oct-14 20-Nov-14 26-Nov-14 1.00 0% 0% 0.00
DHFSH17300 Wet Area False Ceiling Suspension 5.00 22-Oct-14 29-Oct-14 11-Dec-14 16-Dec-14 3.00 0% 0% 0.00
DHFSH17370 Wet Area False Ceiling Tiling/Boarding 4.00 29-Nov-14 03-Dec-14 28-Dec-14 31-Dec-14 8.00 0% 0% 0.00
DHFSH17210 Wet Area Waterproofing 4.00 04-Dec-14 08-Dec-14 03-Jan-15 06-Jan-15 8.00 0% 0% 0.00
DHFSH17220 Wet Area Floor Screed 4.00 09-Dec-14 13-Dec-14 07-Jan-15 11-Jan-15 8.00 0% 0% 0.00
DHFSH17250 Wet Area Floor Tiling 5.00 14-Dec-14 18-Dec-14 12-Jan-15 17-Jan-15 8.00 0% 0% 0.00
DHFSH06610 Cabinet Carcass 5.00 08-Jan-15 13-Jan-15 28-Jan-15 02-Feb-15 -1.00 0% 0% 0.00
DHFSH17420 Installation of Shower Enclosure 4.00 27-May-15 31-May-15 27-Jul-15 30-Jul-15 -38.00 0% 0% 0.00
DHFSH17390 Installation of Vanity Counters & Tops 5.00 30-May-15 03-Jun-15 29-Jul-15 03-Aug-15 -50.00 0% 0% 0.00
DHFSH17800 Installation of Kitchen Cabinet 12.00 29-Jun-15 12-Jul-15 29-Aug-15 10-Sep-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 105.00 28-Aug-14 18-Apr-15 12-Oct-14 14-Feb-15 90.00 0% 0% 0.00
DHFSH17240 Corridor/Lift Lobby Floor Screed 4.00 28-Aug-14 01-Sep-14 12-Oct-14 15-Oct-14 48.00 100% 0% 0.00
DHFSH17270 Lift Lobby Painting - Primer & Stucco 6.00 02-Sep-14 08-Sep-14 16-Oct-14 22-Oct-14 48.00 100% 0% 0.00
DHFSH17310 Lift Lobby False Ceiling Suspension 6.00 29-Oct-14 05-Nov-14 17-Dec-14 23-Dec-14 3.00 0% 0% 0.00
DHFSH17360 Lift Lobby False Ceiling Tiling / Boarding 5.00 29-Nov-14 04-Dec-14 28-Dec-14 03-Jan-15 97.00 0% 0% 0.00
DHFSH17410 Lift Lobby Painting - 1st Coat 6.00 06-Dec-14 11-Dec-14 04-Jan-15 10-Jan-15 97.00 0% 0% 0.00
DHFSH17440 Installation of Steel Doors & Windows 3.00 15-Apr-15 18-Apr-15 03-Feb-15 05-Feb-15 61.00 0% 0% 0.00
DHFSH17470 Lift Lobby Flooring 6.00 12-Jan-15 18-Jan-15 01-Feb-15 07-Feb-15 90.00 0% 0% 0.00
DHFSH17490 Utility Rooms- Epoxy Flooring 6.00 19-Jan-15 25-Jan-15 08-Feb-15 14-Feb-15 90.00 0% 0% 0.00
Staircase 112.00 20-Aug-14 26-Apr-15 01-Oct-14 14-Feb-15 82.00 45.08% 0% 0.00
DHFSH17200 Staircase Plastering 4.00 20-Aug-14 24-Aug-14 01-Oct-14 07-Oct-14 154.00 100% 0% 0.00
DHFSH17280 Staircase Painting - Primer & Stucco 6.00 09-Sep-14 15-Sep-14 23-Oct-14 30-Oct-14 141.00 100% 0% 0.00
DHFSH17320 Staircase Handrail Fixing 3.00 13-Jan-15 17-Jan-15 24-Nov-14 26-Nov-14 138.00 0% 0% 0.00
DHFSH17330 Staircase Painting 1st Coat 3.00 17-Jan-15 20-Jan-15 10-Jan-15 12-Jan-15 103.00 0% 0% 0.00
DHFSH17340 Staircase Final Painting 5.00 19-Apr-15 23-Apr-15 07-Feb-15 11-Feb-15 82.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 22 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH17380 Staircase Epoxy Flooring 2.00 25-Apr-15 26-Apr-15 12-Feb-15 14-Feb-15 82.00 0% 0% 0.00
General 317.00 30-Jun-14 15-Aug-15 01-Jul-14 A 10-Oct-15 -43.00 0% 0% 0.00
DHSTR17000 Access from Structure 0.00 30-Jun-14 01-Jul-14 A 100% 100% 0.00
DHFSH17510 Snagging & De-Snagging 12.00 02-Aug-15 15-Aug-15 27-Sep-15 10-Oct-15 -43.00 0% 0% 0.00
MEP - LEVEL 17 452.00 21-May-14 06-Jul-15 21-May-14 A 01-Sep-15 -44.00 69.07% 69.97% 1.01
DHMEP17000 Embeded Conduits & Boxex - Concrete Works 3.00 21-May-14 24-May-14 21-May-14 A 27-May-14 A 100% 100% 0.00
DHMEP17100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C30a-bJluinng-1 ,4 Wiring et2c0-Jul-14 01-Jul-14 A 26-Aug-14 A 100% 100% 1.00
DHMEP17130 Cable Trays & Cable Trunking 6.00 30-Jul-14 05-Aug-14 01-Jul-14 A 26-Aug-14 A 100% 100% 0.00
DHMEP17160 Pressure Testing of Pipes 12.00 11-Aug-14 24-Aug-14 03-Aug-14 A 27-Aug-14 A 100% 100% 0.00
DHMEP17120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 04-Aug-14 10-Aug-14 10-Aug-14 A 18-Sep-14 A 100% 100% 1.00
DHMEP17110 MEP Works in Risers& Clearance 5.00 13-Sep-14 17-Sep-14 26-Jul-14 A 11-Nov-14 -33.00 100% 69% 0.00
DHMEP17140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es22-Nov-14 27-Nov-14 27-Aug-14 A 27-Dec-14 3.00 0% 31% 0.00
DHMEP17150 MEP Final Fixes 6.00 06-Jun-15 11-Jun-15 05-Aug-15 11-Aug-15 -40.00 0% 0% 0.00
DHMEP06290 Sanitary ware /Toilet accessories 6.00 09-Jun-15 15-Jun-15 09-Aug-15 15-Aug-15 -36.00 0% 0% 0.00
DHMEP17200 Pre-Testing & Commissioning 7.00 29-Jun-15 06-Jul-15 25-Aug-15 01-Sep-15 -44.00 0% 0% 0.00
LEVEL 18 486.00 15-May-14 22-Aug-15 15-May-14 A 18-Oct-15 -43.00 69.44% 65.98% 0.95
STRUCTURAL WORKS -LEVEL 18 16.00 15-May-14 03-Jun-14 15-May-14 A 05-Jun-14 A 100% 100% 1.00
DHCWA19100 Core Wall - Level 18 5.00 15-May-14 20-May-14 15-May-14 A 19-May-14 A 100% 100% 1.00
DHSLA18100 Construction of Horizontals - L18 3.00 29-May-14 01-Jun-14 28-May-14 A 03-Jun-14 A 100% 100% 1.00
DHCWA19110 Construction of Verticals - L18 2.00 02-Jun-14 03-Jun-14 04-Jun-14 A 05-Jun-14 A 100% 100% 1.00
STAIRCASES 4.00 17-Aug-14 20-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0% 0.00
A1540 Stair # 1 4.00 17-Aug-14 20-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00
A1550 Stair # 2 3.00 18-Aug-14 20-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 18 323.00 03-Jul-14 22-Aug-15 06-Jul-14 A 18-Oct-15 -43.00 23.05% 6.45% 0.28
Dry area 298.00 30-Jul-14 28-Jul-15 15-Jul-14 A 27-Sep-15 -38.00 35.49% 13.7% 0.39
DHFSH18120 Marking,Cutting & Chasing - Dry Area 4.00 06-Aug-14 10-Aug-14 17-Aug-14 A 19-Aug-14 A 100% 100% 1.00
DHFSH18100 Block Work in Dry Area 6.00 30-Jul-14 05-Aug-14 15-Jul-14 A 01-Oct-14 1.00 100% 50% 0.50
DHFSH18130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 11-Aug-14 14-Aug-14 09-Sep-14 A 02-Oct-14 41.00 100% 20% 0.20
DHFSH18160 Plaster in Dry Area 8.00 18-Aug-14 26-Aug-14 06-Oct-14 A 14-Oct-14 41.00 100% 2% 0.02
DHMEP18190 Dry Area Floor Screed 7.00 27-Aug-14 03-Sep-14 15-Oct-14 22-Oct-14 41.00 100% 0% 0.00
DHFSH18230 Dry Area Painting - Primer 4.00 04-Sep-14 08-Sep-14 23-Oct-14 28-Oct-14 84.00 100% 0% 0.00
DHFSH18260 Dry Area Painting - Stucco 6.00 09-Sep-14 15-Sep-14 29-Oct-14 04-Nov-14 84.00 100% 0% 0.00
DHFSH18290 Dry Area False Ceiling Suspension 6.00 20-Oct-14 28-Oct-14 09-Dec-14 15-Dec-14 -15.00 0% 0% 0.00
DHFSH18350 Dry Area False Ceiling Tiling / Boarding 5.00 03-Dec-14 08-Dec-14 03-Jan-15 07-Jan-15 31.00 0% 0% 0.00
DHFSH18400 Dry Area Painting - 1st Coat 5.00 09-Dec-14 14-Dec-14 08-Jan-15 13-Jan-15 31.00 0% 0% 0.00
DHFSH18450 Dry Area Flooring 5.00 12-Jan-15 17-Jan-15 01-Feb-15 05-Feb-15 16.00 0% 0% 0.00
DHFSH18430 Installation of Timber Doors & Ironmongery 5.00 27-May-15 01-Jun-15 27-Jul-15 01-Aug-15 -50.00 0% 0% 0.00
DHFSH18802 Installation of Wardrobe 12.00 29-Jun-15 12-Jul-15 29-Aug-15 10-Sep-15 -50.00 0% 0% 0.00
DHFSH18500 Paint Final Coat 6.00 22-Jul-15 28-Jul-15 19-Sep-15 27-Sep-15 -38.00 0% 0% 0.00
Wet area 292.00 30-Jul-14 21-Jul-15 15-Jul-14 A 17-Sep-15 -50.00 10.35% 1.59% 0.15
DHFSH18140 Marking,Cutting & Chasing - Wet Area 4.00 06-Aug-14 10-Aug-14 17-Aug-14 A 19-Aug-14 A 100% 100% 1.00
DHFSH18110 Block Work in Wet Area 6.00 30-Jul-14 05-Aug-14 15-Jul-14 A 01-Oct-14 38.00 100% 50% 0.00
DHFSH18150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 11-Aug-14 14-Aug-14 09-Sep-14 A 02-Oct-14 38.00 100% 20% 0.20
DHMEP18170 Plaster in Wet Area 4.00 18-Aug-14 21-Aug-14 06-Oct-14 A 09-Oct-14 38.00 100% 2% 0.02
DHMEP18180 Wet Area Wall Tiling 7.00 19-Oct-14 28-Oct-14 24-Nov-14 01-Dec-14 1.00 0% 0% 0.00
DHFSH18300 Wet Area False Ceiling Suspension 5.00 28-Oct-14 03-Nov-14 16-Dec-14 21-Dec-14 2.00 0% 0% 0.00
DHFSH18370 Wet Area False Ceiling Tiling/Boarding 4.00 03-Dec-14 07-Dec-14 03-Jan-15 06-Jan-15 9.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Pressure Testing of Pipes
Embeded Condiuts,Boxes and Sleeves in Walls
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - Level 18
Construction of Horizontals - L18
Construction of Verticals - L18
Stair # 1
Stair # 2
Marking,Cutting & Chasing - Dry Area
Block Work in Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Marking,Cutting & Chasing - Wet Area
Block Work in Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 23 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH18210 Wet Area Waterproofing 4.00 08-Dec-14 11-Dec-14 07-Jan-15 11-Jan-15 9.00 0% 0% 0.00
DHFSH18220 Wet Area Floor Screed 4.00 13-Dec-14 16-Dec-14 12-Jan-15 15-Jan-15 9.00 0% 0% 0.00
DHFSH18250 Wet Area Floor Tiling 5.00 17-Dec-14 22-Dec-14 17-Jan-15 21-Jan-15 9.00 0% 0% 0.00
DHFSH06620 Cabinet Carcass 5.00 14-Jan-15 19-Jan-15 03-Feb-15 08-Feb-15 -1.00 0% 0% 0.00
DHFSH18420 Installation of Shower Enclosure 4.00 01-Jun-15 04-Jun-15 01-Aug-15 04-Aug-15 -39.00 0% 0% 0.00
DHFSH18390 Installation of Vanity Counters & Tops 5.00 03-Jun-15 08-Jun-15 03-Aug-15 08-Aug-15 -50.00 0% 0% 0.00
DHFSH18800 Installation of Kitchen Cabinet 12.00 06-Jul-15 21-Jul-15 05-Sep-15 17-Sep-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 100.00 04-Sep-14 21-Apr-15 23-Oct-14 19-Feb-15 87.00 0% 0% 0.00
DHFSH18240 Corridor/Lift Lobby Floor Screed 4.00 04-Sep-14 08-Sep-14 23-Oct-14 28-Oct-14 41.00 100% 0% 0.00
DHFSH18270 Lift Lobby Painting - Primer & Stucco 6.00 09-Sep-14 15-Sep-14 29-Oct-14 04-Nov-14 41.00 100% 0% 0.00
DHFSH18310 Lift Lobby False Ceiling Suspension 6.00 03-Nov-14 10-Nov-14 22-Dec-14 28-Dec-14 2.00 0% 0% 0.00
DHFSH18360 Lift Lobby False Ceiling Tiling / Boarding 5.00 03-Dec-14 08-Dec-14 03-Jan-15 07-Jan-15 96.00 0% 0% 0.00
DHFSH18410 Lift Lobby Painting - 1st Coat 6.00 09-Dec-14 15-Dec-14 08-Jan-15 14-Jan-15 96.00 0% 0% 0.00
DHFSH18440 Installation of Steel Doors & Windows 3.00 19-Apr-15 21-Apr-15 09-Feb-15 11-Feb-15 59.00 0% 0% 0.00
DHFSH18470 Lift Lobby Flooring 6.00 18-Jan-15 24-Jan-15 07-Feb-15 12-Feb-15 87.00 0% 0% 0.00
DHFSH18490 Utility Rooms- Epoxy Flooring 6.00 25-Jan-15 31-Jan-15 14-Feb-15 19-Feb-15 87.00 0% 0% 0.00
Staircase 107.00 27-Aug-14 29-Apr-15 15-Oct-14 19-Feb-15 81.00 45.08% 0% 0.00
DHFSH18200 Staircase Plastering 5.00 27-Aug-14 01-Sep-14 15-Oct-14 20-Oct-14 146.00 100% 0% 0.00
DHFSH18280 Staircase Painting - Primer & Stucco 6.00 16-Sep-14 22-Sep-14 05-Nov-14 11-Nov-14 134.00 100% 0% 0.00
DHFSH18320 Staircase Handrail Fixing 3.00 17-Jan-15 20-Jan-15 27-Nov-14 30-Nov-14 139.00 0% 0% 0.00
DHFSH18330 Staircase Painting 1st Coat 3.00 20-Jan-15 24-Jan-15 14-Jan-15 17-Jan-15 103.00 0% 0% 0.00
DHFSH18340 Staircase Final Painting 5.00 22-Apr-15 27-Apr-15 12-Feb-15 17-Feb-15 81.00 0% 0% 0.00
DHFSH18380 Staircase Epoxy Flooring 2.00 28-Apr-15 29-Apr-15 18-Feb-15 19-Feb-15 81.00 0% 0% 0.00
General 323.00 03-Jul-14 22-Aug-15 06-Jul-14 A 18-Oct-15 -43.00 0% 0% 0.00
DHSTR18000 Access from Structure 0.00 03-Jul-14 06-Jul-14 A 100% 100% 0.00
DHFSH18510 Snagging & De-Snagging 12.00 09-Aug-15 22-Aug-15 04-Oct-15 18-Oct-15 -43.00 0% 0% 0.00
MEP - LEVEL 18 455.00 29-May-14 13-Jul-15 28-May-14 A 08-Sep-15 -44.00 69.07% 69.97% 1.01
DHMEP18000 Embeded Conduits & Boxex - Concrete Works 3.00 29-May-14 01-Jun-14 28-May-14 A 03-Jun-14 A 100% 100% 0.00
DHMEP18100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C06a-bJluinl-g1 4, Wiring et2c6-Jul-14 06-Jul-14 A 27-Aug-14 A 100% 100% 1.00
DHMEP18130 Cable Trays & Cable Trunking 6.00 06-Aug-14 12-Aug-14 06-Jul-14 A 27-Aug-14 A 100% 100% 0.00
DHMEP18120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 11-Aug-14 17-Aug-14 24-Aug-14 A 18-Sep-14 A 100% 100% 1.00
DHMEP18160 Pressure Testing of Pipes 12.00 18-Aug-14 31-Aug-14 16-Aug-14 A 23-Sep-14 A 100% 100% 0.00
DHMEP18110 MEP Works in Risers& Clearance 5.00 18-Sep-14 23-Sep-14 04-Aug-14 A 17-Nov-14 -33.00 100% 60% 0.00
DHMEP18140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es25-Nov-14 01-Dec-14 02-Sep-14 A 31-Dec-14 2.00 0% 31% 0.00
DHMEP18150 MEP Final Fixes 6.00 13-Jun-15 18-Jun-15 12-Aug-15 18-Aug-15 -36.00 0% 0% 0.00
DHMEP06300 Sanitary ware /Toilet accessories 6.00 16-Jun-15 22-Jun-15 16-Aug-15 22-Aug-15 -36.00 0% 0% 0.00
DHMEP18200 Pre-Testing & Commissioning 7.00 06-Jul-15 13-Jul-15 01-Sep-15 08-Sep-15 -44.00 0% 0% 0.00
LEVEL 19 489.00 21-May-14 29-Aug-15 20-May-14 A 25-Oct-15 -43.00 69.61% 69.2% 0.99
STRUCTURAL WORKS -LEVEL 19 106.00 21-May-14 09-Jun-14 20-May-14 A 12-Jun-14 A 100% 100% 1.00
DHCWA20120 Tower Crane Jump 1.00 26-May-14 26-May-14 20-May-14 A 20-May-14 A 100% 100% 0.00
DHCWA20100 Core Wall - Level 19 5.00 21-May-14 26-May-14 20-May-14 A 26-May-14 A 100% 100% 1.00
DHSLA191000 Construction of Horizontals - L19 3.00 04-Jun-14 07-Jun-14 04-Jun-14 A 09-Jun-14 A 100% 100% 1.00
DHCWA20110 Construction of Verticals - L19 2.00 08-Jun-14 09-Jun-14 10-Jun-14 A 12-Jun-14 A 100% 100% 1.00
STAIRCASES 4.00 24-Aug-14 27-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0% 0.00
A1560 Stair # 1 4.00 24-Aug-14 27-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00
A1570 Stair # 2 3.00 25-Aug-14 27-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 19 329.00 07-Jul-14 29-Aug-15 09-Jul-14 A 25-Oct-15 -43.00 23.05% 19.64% 0.85
Dry area 301.00 04-Aug-14 04-Aug-15 20-Jul-14 A 04-Oct-15 -38.00 35.49% 35.49% 1.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Tower Crane Jump
Core Wall - Level 19
Construction of Horizontals - L19
Construction of Verticals - L19
Stair # 1
Stair # 2
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 24 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH19100 Block Work in Dry Area 6.00 04-Aug-14 10-Aug-14 20-Jul-14 A 24-Aug-14 A 100% 100% 1.00
DHFSH19120 Marking,Cutting & Chasing - Dry Area 4.00 11-Aug-14 14-Aug-14 19-Aug-14 A 24-Aug-14 A 100% 100% 1.00
DHFSH19130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 16-Aug-14 19-Aug-14 09-Sep-14 A 14-Sep-14 A 100% 100% 1.00
DHFSH19160 Plaster in Dry Area 9.00 23-Aug-14 01-Sep-14 14-Sep-14 A 24-Sep-14 A 100% 100% 1.00
DHMEP19190 Dry Area Floor Screed 7.00 02-Sep-14 09-Sep-14 09-Oct-14 16-Oct-14 49.00 100% 0% 0.00
DHFSH19230 Dry Area Painting - Primer 4.00 10-Sep-14 14-Sep-14 18-Oct-14 21-Oct-14 94.00 100% 0% 0.00
DHFSH19260 Dry Area Painting - Stucco 6.00 15-Sep-14 21-Sep-14 22-Oct-14 29-Oct-14 94.00 100% 0% 0.00
DHFSH19290 Dry Area False Ceiling Suspension 6.00 26-Oct-14 02-Nov-14 14-Dec-14 20-Dec-14 -15.00 0% 0% 0.00
DHFSH19350 Dry Area False Ceiling Tiling / Boarding 5.00 07-Dec-14 11-Dec-14 07-Jan-15 12-Jan-15 32.00 0% 0% 0.00
DHFSH19400 Dry Area Painting - 1st Coat 5.00 13-Dec-14 17-Dec-14 13-Jan-15 18-Jan-15 32.00 0% 0% 0.00
DHFSH19450 Dry Area Flooring 5.00 18-Jan-15 22-Jan-15 07-Feb-15 11-Feb-15 16.00 0% 0% 0.00
DHFSH19430 Installation of Timber Doors & Ironmongery 4.00 02-Jun-15 06-Jun-15 02-Aug-15 05-Aug-15 -50.00 0% 0% 0.00
DHFSH19802 Installation of Wardrobe 12.00 06-Jul-15 21-Jul-15 05-Sep-15 17-Sep-15 -50.00 0% 0% 0.00
DHFSH19500 Paint Final Coat 6.00 29-Jul-15 04-Aug-15 28-Sep-15 04-Oct-15 -38.00 0% 0% 0.00
Wet area 295.00 04-Aug-14 28-Jul-15 20-Jul-14 A 27-Sep-15 -50.00 10.35% 10.35% 1.00
DHFSH19110 Block Work in Wet Area 6.00 04-Aug-14 10-Aug-14 20-Jul-14 A 24-Aug-14 A 100% 100% 0.00
DHFSH19140 Marking,Cutting & Chasing - Wet Area 4.00 11-Aug-14 14-Aug-14 19-Aug-14 A 24-Aug-14 A 100% 100% 1.00
DHFSH19150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 16-Aug-14 19-Aug-14 09-Sep-14 A 14-Sep-14 A 100% 100% 1.00
DHMEP19170 Plaster in Wet Area 4.00 23-Aug-14 26-Aug-14 14-Sep-14 A 24-Sep-14 A 100% 100% 1.00
DHMEP19180 Wet Area Wall Tiling 7.00 23-Oct-14 02-Nov-14 29-Nov-14 07-Dec-14 1.00 0% 0% 0.00
DHFSH19300 Wet Area False Ceiling Suspension 5.00 02-Nov-14 08-Nov-14 21-Dec-14 25-Dec-14 1.00 0% 0% 0.00
DHFSH19370 Wet Area False Ceiling Tiling/Boarding 4.00 07-Dec-14 10-Dec-14 07-Jan-15 11-Jan-15 10.00 0% 0% 0.00
DHFSH19210 Wet Area Waterproofing 4.00 11-Dec-14 15-Dec-14 12-Jan-15 15-Jan-15 10.00 0% 0% 0.00
DHFSH19220 Wet Area Floor Screed 4.00 16-Dec-14 20-Dec-14 17-Jan-15 20-Jan-15 10.00 0% 0% 0.00
DHFHS19250 Wet Area Floor Tiling 5.00 21-Dec-14 25-Dec-14 21-Jan-15 26-Jan-15 10.00 0% 0% 0.00
DHFSH06630 Cabinet Carcass 5.00 20-Jan-15 25-Jan-15 09-Feb-15 14-Feb-15 -1.00 0% 0% 0.00
DHFSH19420 Installation of Shower Enclosure 4.00 06-Jun-15 09-Jun-15 05-Aug-15 09-Aug-15 -40.00 0% 0% 0.00
DHFSH19390 Installation of Vanity Counters & Tops 5.00 08-Jun-15 13-Jun-15 08-Aug-15 12-Aug-15 -50.00 0% 0% 0.00
DHFSH19800 Installation of Kitchen Cabinet 12.00 13-Jul-15 28-Jul-15 12-Sep-15 27-Sep-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 110.00 10-Sep-14 25-Apr-15 18-Oct-14 25-Feb-15 84.00 0% 0% 0.00
DHFSH19240 Corridor/Lift Lobby Floor Screed 4.00 10-Sep-14 14-Sep-14 18-Oct-14 21-Oct-14 49.00 100% 0% 0.00
DHFSH19270 Lift Lobby Painting - Primer & Stucco 6.00 15-Sep-14 21-Sep-14 22-Oct-14 29-Oct-14 49.00 100% 0% 0.00
DHFSH19310 Lift Lobby False Ceiling Suspension 6.00 08-Nov-14 15-Nov-14 27-Dec-14 03-Jan-15 1.00 0% 0% 0.00
DHFSH19360 Lift Lobby False Ceiling Tiling / Boarding 5.00 07-Dec-14 11-Dec-14 07-Jan-15 12-Jan-15 95.00 0% 0% 0.00
DHFSH19410 Lift Lobby Painting - 1st Coat 6.00 13-Dec-14 18-Dec-14 13-Jan-15 19-Jan-15 95.00 0% 0% 0.00
DHFSH19440 Installation of Steel Doors & Windows 3.00 22-Apr-15 25-Apr-15 15-Feb-15 17-Feb-15 57.00 0% 0% 0.00
DHFSH19470 Lift Lobby Flooring 6.00 24-Jan-15 29-Jan-15 12-Feb-15 18-Feb-15 84.00 0% 0% 0.00
DHFSH19490 Utility Rooms- Epoxy Flooring 6.00 31-Jan-15 05-Feb-15 19-Feb-15 25-Feb-15 84.00 0% 0% 0.00
Staircase 117.00 02-Sep-14 03-May-15 09-Oct-14 25-Feb-15 81.00 45.08% 0% 0.00
DHFSH19200 Staircase Plastering 4.00 02-Sep-14 06-Sep-14 09-Oct-14 13-Oct-14 155.00 100% 0% 0.00
DHFSH19280 Staircase Painting - Primer & Stucco 6.00 22-Sep-14 28-Sep-14 30-Oct-14 05-Nov-14 142.00 100% 0% 0.00
DHFSH19320 Staircase Handrail Fixing 3.00 20-Jan-15 24-Jan-15 01-Dec-14 04-Dec-14 140.00 0% 0% 0.00
DHFSH19330 Staircase Painting 1st Coat 3.00 24-Jan-15 27-Jan-15 19-Jan-15 21-Jan-15 103.00 0% 0% 0.00
DHFSH19340 Staircase Final Painting 5.00 26-Apr-15 30-Apr-15 18-Feb-15 23-Feb-15 81.00 0% 0% 0.00
DHFSH19380 Staircase Epoxy Flooring 2.00 02-May-15 03-May-15 24-Feb-15 25-Feb-15 81.00 0% 0% 0.00
General 329.00 07-Jul-14 29-Aug-15 09-Jul-14 A 25-Oct-15 -43.00 0% 0% 0.00
DHSTR19000 Access from Structure 0.00 07-Jul-14 09-Jul-14 A 100% 100% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 25 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH19510 Snagging & De-Snagging 12.00 16-Aug-15 29-Aug-15 11-Oct-15 25-Oct-15 -43.00 0% 0% 0.00
MEP - LEVEL 19 455.00 04-Jun-14 16-Jul-15 04-Jun-14 A 12-Sep-15 -44.00 69.41% 70.32% 1.01
DHMEP19000 Embeded Conduits & Boxex - Concrete Works 3.00 04-Jun-14 07-Jun-14 04-Jun-14 A 09-Jun-14 A 100% 100% 0.00
DHMEP19100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C12a-bJluinl-g1 4, Wiring et0c3-Aug-14 09-Jul-14 A 30-Aug-14 A 100% 100% 1.00
DHMEP19130 Cable Trays & Cable Trunking 6.00 11-Aug-14 17-Aug-14 09-Jul-14 A 30-Aug-14 A 100% 100% 0.00
DHMEP19120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 16-Aug-14 21-Aug-14 25-Aug-14 A 20-Sep-14 A 100% 100% 1.00
DHMEP19160 Pressure Testing of Pipes 12.00 23-Aug-14 04-Sep-14 17-Aug-14 A 12-Oct-14 68.00 100% 86% 0.00
DHMEP19110 MEP Works in Risers& Clearance 6.00 24-Sep-14 30-Sep-14 16-Aug-14 A 23-Nov-14 -33.00 100% 21% 0.00
DHMEP19140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es29-Nov-14 06-Dec-14 04-Sep-14 A 06-Jan-15 1.00 0% 31% 0.00
DHMEP19150 MEP Final Fixes 6.00 10-Jun-15 16-Jun-15 10-Aug-15 16-Aug-15 -40.00 0% 0% 0.00
DHMEP06310 Sanitary ware /Toilet accessories 6.00 17-Jun-15 23-Jun-15 17-Aug-15 23-Aug-15 -34.00 0% 0% 0.00
DHMEP19200 Pre-Testing & Commissioning 7.00 09-Jul-15 16-Jul-15 05-Sep-15 12-Sep-15 -44.00 0% 0% 0.00
LEVEL 20 504.00 28-May-14 05-Sep-15 27-May-14 A 01-Nov-15 -43.00 69.7% 68.58% 0.98
STRUCTURAL WORKS - LEVEL 20 16.00 28-May-14 15-Jun-14 27-May-14 A 18-Jun-14 A 100% 100% 1.00
DHCWA21100 Core Wall - Level 20 4.00 28-May-14 01-Jun-14 27-May-14 A 31-May-14 A 100% 100% 1.00
DHSLA20100 Construction of Horizontals - L20 3.00 10-Jun-14 12-Jun-14 11-Jun-14 A 14-Jun-14 A 100% 100% 1.00
DHCWA21110 Construction of Verticals - L20 2.00 14-Jun-14 15-Jun-14 15-Jun-14 A 18-Jun-14 A 100% 100% 1.00
STAIRCASES 4.00 01-Sep-14 04-Sep-14 02-Aug-14 A 06-Aug-14 A 0% 0% 0.00
A1580 Stair # 1 4.00 01-Sep-14 04-Sep-14 02-Aug-14 A 06-Aug-14 A 100% 100% 0.00
A1590 Stair # 2 3.00 02-Sep-14 04-Sep-14 02-Aug-14 A 06-Aug-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 20 335.00 13-Jul-14 05-Sep-15 14-Jul-14 A 01-Nov-15 -43.00 23.05% 17.59% 0.76
Dry area 307.00 10-Aug-14 11-Aug-15 29-Jul-14 A 11-Oct-15 -38.00 35.49% 33.03% 0.93
DHFSH20100 Block Work in Dry Area 6.00 10-Aug-14 16-Aug-14 29-Jul-14 A 25-Aug-14 A 100% 100% 1.00
DHFSH20120 Marking,Cutting & Chasing - Dry Area 4.00 17-Aug-14 20-Aug-14 21-Aug-14 A 27-Aug-14 A 100% 100% 1.00
DHFSH20130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 21-Aug-14 25-Aug-14 11-Sep-14 A 18-Sep-14 A 100% 100% 1.00
DHFSH20160 Plaster in Dry Area 8.00 28-Aug-14 06-Sep-14 14-Sep-14 A 11-Oct-14 50.00 100% 70% 0.70
DHMEP20190 Dry Area Floor Screed 7.00 07-Sep-14 14-Sep-14 12-Oct-14 19-Oct-14 50.00 100% 0% 0.00
DHFSH20230 Dry Area Painting - Primer 4.00 15-Sep-14 18-Sep-14 20-Oct-14 23-Oct-14 97.00 100% 0% 0.00
DHFSH20260 Dry Area Painting - Stucco 6.00 20-Sep-14 25-Sep-14 26-Oct-14 01-Nov-14 97.00 100% 0% 0.00
DHFSH20290 Dry Area False Ceiling Suspension 6.00 30-Oct-14 06-Nov-14 18-Dec-14 24-Dec-14 -15.00 0% 0% 0.00
DHFSH20350 Dry Area False Ceiling Tiling / Boarding 5.00 10-Dec-14 15-Dec-14 12-Jan-15 17-Jan-15 33.00 0% 0% 0.00
DHFSH20400 Dry Area Painting - 1st Coat 5.00 16-Dec-14 21-Dec-14 18-Jan-15 22-Jan-15 33.00 0% 0% 0.00
DHFSH20450 Dry Area Flooring 5.00 24-Jan-15 28-Jan-15 12-Feb-15 17-Feb-15 16.00 0% 0% 0.00
DHFSH20430 Installation of Timber Doors & Ironmongery 4.00 07-Jun-15 10-Jun-15 06-Aug-15 10-Aug-15 -50.00 0% 0% 0.00
DHFSH20802 Installation of Wardrobe 12.00 11-Jul-15 26-Jul-15 09-Sep-15 22-Sep-15 -50.00 0% 0% 0.00
DHFSH20500 Paint Final Coat 6.00 05-Aug-15 11-Aug-15 05-Oct-15 11-Oct-15 -38.00 0% 0% 0.00
Wet area 301.00 10-Aug-14 04-Aug-15 29-Jul-14 A 04-Oct-15 -50.00 10.35% 8.17% 0.79
DHFSH20110 Block Work in Wet Area 6.00 10-Aug-14 16-Aug-14 29-Jul-14 A 25-Aug-14 A 100% 100% 0.00
DHFSH20140 Marking,Cutting & Chasing - Wet Area 4.00 17-Aug-14 20-Aug-14 21-Aug-14 A 27-Aug-14 A 100% 100% 1.00
DHFSH20150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 21-Aug-14 25-Aug-14 11-Sep-14 A 18-Sep-14 A 100% 100% 1.00
DHMEP20170 Plaster in Wet Area 4.00 28-Aug-14 01-Sep-14 14-Sep-14 A 09-Oct-14 47.00 100% 70% 0.70
DHMEP20180 Wet Area Wall Tiling 6.00 30-Oct-14 06-Nov-14 06-Dec-14 11-Dec-14 1.00 0% 0% 0.00
DHFSH20300 Wet Area False Ceiling Suspension 5.00 06-Nov-14 12-Nov-14 25-Dec-14 30-Dec-14 0.00 0% 0% 0.00
DHFSH20370 Wet Area False Ceiling Tiling/Boarding 4.00 10-Dec-14 14-Dec-14 12-Jan-15 15-Jan-15 11.00 0% 0% 0.00
DHFSH20210 Wet Area Waterproofing 4.00 15-Dec-14 18-Dec-14 17-Jan-15 20-Jan-15 11.00 0% 0% 0.00
DHFSH20220 Wet Area Floor Screed 4.00 20-Dec-14 23-Dec-14 21-Jan-15 25-Jan-15 11.00 0% 0% 0.00
DHFSH20250 Wet Area Floor Tiling 5.00 24-Dec-14 29-Dec-14 26-Jan-15 31-Jan-15 11.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - Level 20
Construction of Horizontals - L20
Construction of Verticals - L20
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 26 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH06640 Cabinet Carcass 5.00 26-Jan-15 31-Jan-15 15-Feb-15 19-Feb-15 -1.00 0% 0% 0.00
DHFSH20420 Installation of Shower Enclosure 4.00 10-Jun-15 14-Jun-15 10-Aug-15 13-Aug-15 -40.00 0% 0% 0.00
DHFSH20390 Installation of Vanity Counters & Tops 5.00 13-Jun-15 17-Jun-15 12-Aug-15 17-Aug-15 -50.00 0% 0% 0.00
DHFSH20800 Installation of Kitchen Cabinet 12.00 22-Jul-15 04-Aug-15 19-Sep-15 04-Oct-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 113.00 15-Sep-14 28-Apr-15 20-Oct-14 03-Mar-15 81.00 0% 0% 0.00
DHFSH20240 Corridor/Lift Lobby Floor Screed 4.00 15-Sep-14 18-Sep-14 20-Oct-14 23-Oct-14 50.00 100% 0% 0.00
DHFSH20270 Lift Lobby Painting - Primer & Stucco 6.00 20-Sep-14 25-Sep-14 26-Oct-14 01-Nov-14 50.00 100% 0% 0.00
DHFSH20310 Lift Lobby False Ceiling Suspension 6.00 12-Nov-14 19-Nov-14 31-Dec-14 07-Jan-15 0.00 0% 0% 0.00
DHFSH20360 Lift Lobby False Ceiling Tiling / Boarding 5.00 10-Dec-14 15-Dec-14 12-Jan-15 17-Jan-15 94.00 0% 0% 0.00
DHFSH20410 Lift Lobby Painting - 1st Coat 6.00 16-Dec-14 22-Dec-14 18-Jan-15 24-Jan-15 94.00 0% 0% 0.00
DHFSH20440 Installation of Steel Doors & Windows 3.00 26-Apr-15 28-Apr-15 21-Feb-15 23-Feb-15 55.00 0% 0% 0.00
DHFSH20470 Lift Lobby Flooring 6.00 29-Jan-15 04-Feb-15 18-Feb-15 24-Feb-15 81.00 0% 0% 0.00
DHFSH20490 Utility Rooms- Epoxy Flooring 6.00 05-Feb-15 11-Feb-15 25-Feb-15 03-Mar-15 81.00 0% 0% 0.00
Staircase 120.00 07-Sep-14 06-May-15 12-Oct-14 03-Mar-15 80.00 45.08% 0% 0.00
DHFSH20200 Staircase Plastering 4.00 07-Sep-14 10-Sep-14 12-Oct-14 15-Oct-14 156.00 100% 0% 0.00
DHFSH20280 Staircase Painting - Primer & Stucco 6.00 27-Sep-14 02-Oct-14 02-Nov-14 08-Nov-14 143.00 66.67% 0% 0.00
DHFSH20320 Staircase Handrail Fixing 3.00 24-Jan-15 27-Jan-15 06-Dec-14 08-Dec-14 140.00 0% 0% 0.00
DHFSH20330 Staircase Painting 1st Coat 3.00 27-Jan-15 31-Jan-15 24-Jan-15 26-Jan-15 102.00 0% 0% 0.00
DHFSH20340 Staircase Final Painting 5.00 29-Apr-15 04-May-15 24-Feb-15 01-Mar-15 80.00 0% 0% 0.00
DHFSH20380 Staircase Epoxy Flooring 2.00 05-May-15 06-May-15 02-Mar-15 03-Mar-15 80.00 0% 0% 0.00
General 335.00 13-Jul-14 05-Sep-15 14-Jul-14 A 01-Nov-15 -43.00 0% 0% 0.00
DHSTR20000 Access from Structure 0.00 13-Jul-14 14-Jul-14 A 100% 100% 0.00
DHFSH20510 Snagging & De-Snagging 12.00 23-Aug-15 05-Sep-15 19-Oct-15 01-Nov-15 -43.00 0% 0% 0.00
MEP - LEVEL 20 467.00 10-Jun-14 22-Jul-15 11-Jun-14 A 15-Sep-15 -44.00 69.55% 69.9% 1.01
DHMEP20000 Embeded Conduits & Boxex - Concrete Works 3.00 10-Jun-14 12-Jun-14 11-Jun-14 A 14-Jun-14 A 100% 100% 0.00
DHMEP20100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C15a-bJluinl-g1 4, Wiring et0c6-Aug-14 14-Jul-14 A 03-Sep-14 A 100% 100% 1.00
DHMEP20130 Cable Trays & Cable Trunking 6.00 17-Aug-14 23-Aug-14 14-Jul-14 A 03-Sep-14 A 100% 100% 0.00
DHMEP20120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 21-Aug-14 27-Aug-14 25-Aug-14 A 22-Sep-14 A 100% 100% 1.00
DHMEP20160 Pressure Testing of Pipes 12.00 28-Aug-14 10-Sep-14 24-Aug-14 A 13-Oct-14 70.00 100% 53% 0.00
DHMEP20110 MEP Works in Risers& Clearance 6.00 01-Oct-14 09-Oct-14 17-Aug-14 A 29-Nov-14 -33.00 0% 21% 0.00
DHMEP20140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es03-Dec-14 09-Dec-14 07-Sep-14 A 11-Jan-15 0.00 0% 12% 0.00
DHMEP20150 MEP Final Fixes 6.00 15-Jun-15 21-Jun-15 15-Aug-15 20-Aug-15 -40.00 0% 0% 0.00
DHMEP06320 Sanitary ware /Toilet accessories 6.00 18-Jun-15 24-Jun-15 18-Aug-15 24-Aug-15 -32.00 0% 0% 0.00
DHMEP20200 Pre-Testing & Commissioning 7.00 13-Jul-15 22-Jul-15 08-Sep-15 15-Sep-15 -44.00 0% 0% 0.00
LEVEL 21 515.00 02-Jun-14 12-Sep-15 01-Jun-14 A 14-Nov-15 -48.00 69.72% 67.71% 0.97
STRUCTURAL WORKS - LEVEL 21 17.00 02-Jun-14 21-Jun-14 01-Jun-14 A 24-Jun-14 A 100% 100% 1.00
DHCWA22100 Core Wall - Level 21 4.00 02-Jun-14 05-Jun-14 01-Jun-14 A 06-Jun-14 A 100% 100% 1.00
DHSLA21100 Construction of Horizontals - L21 3.00 16-Jun-14 18-Jun-14 18-Jun-14 A 21-Jun-14 A 100% 100% 1.00
DHCWA22110 Construction of Verticals - L21 2.00 19-Jun-14 21-Jun-14 22-Jun-14 A 24-Jun-14 A 100% 100% 1.00
STAIRCASES 4.00 07-Sep-14 10-Sep-14 07-Aug-14 A 12-Aug-14 A 0% 0% 0.00
A1600 Stair # 1 4.00 07-Sep-14 10-Sep-14 07-Aug-14 A 12-Aug-14 A 100% 100% 0.00
A1610 Stair # 2 3.00 08-Sep-14 10-Sep-14 07-Aug-14 A 12-Aug-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 21 341.00 20-Jul-14 12-Sep-15 22-Jul-14 A 08-Nov-15 -43.00 23.05% 13.69% 0.59
Dry area 313.00 14-Aug-14 18-Aug-15 10-Aug-14 A 19-Oct-15 -38.00 35.49% 28.35% 0.80
DHFSH21120 Marking,Cutting & Chasing - Dry Area 4.00 21-Aug-14 25-Aug-14 12-Aug-14 A 24-Aug-14 A 100% 100% 1.00
DHFSH21100 Block Work in Dry Area 6.00 14-Aug-14 20-Aug-14 10-Aug-14 A 25-Aug-14 A 100% 100% 1.00
DHFSH21130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 26-Aug-14 30-Aug-14 15-Sep-14 A 21-Sep-14 A 100% 100% 1.00
DHFSH21160 Plaster in Dry Area 8.00 03-Sep-14 11-Sep-14 22-Sep-14 A 16-Oct-14 48.00 100% 13% 0.13
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - Level 21
Construction of Horizontals - L21
Construction of Verticals - L21
Stair # 1
Stair # 2
Marking,Cutting & Chasing - Dry Area
Block Work in Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 27 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHMEP21190 Dry Area Floor Screed 7.00 13-Sep-14 20-Sep-14 18-Oct-14 26-Oct-14 48.00 100% 0% 0.00
DHFSH21230 Dry Area Painting - Primer 4.00 21-Sep-14 24-Sep-14 27-Oct-14 30-Oct-14 97.00 100% 0% 0.00
DHFSH21260 Dry Area Painting - Stucco 6.00 25-Sep-14 01-Oct-14 01-Nov-14 06-Nov-14 97.00 83.33% 0% 0.00
DHFSH21290 Dry Area False Ceiling Suspension 6.00 04-Nov-14 11-Nov-14 23-Dec-14 29-Dec-14 -15.00 0% 0% 0.00
DHFSH21350 Dry Area False Ceiling Tiling / Boarding 5.00 14-Dec-14 18-Dec-14 17-Jan-15 21-Jan-15 34.00 0% 0% 0.00
DHFSH21400 Dry Area Painting - 1st Coat 5.00 20-Dec-14 24-Dec-14 22-Jan-15 27-Jan-15 34.00 0% 0% 0.00
DHFSH21450 Dry Area Flooring 5.00 29-Jan-15 03-Feb-15 18-Feb-15 23-Feb-15 16.00 0% 0% 0.00
DHFSH21430 Installation of Timber Doors & Ironmongery 4.00 11-Jun-15 15-Jun-15 11-Aug-15 15-Aug-15 -50.00 0% 0% 0.00
DHFSH21802 Installation of Wardrobe 12.00 15-Jul-15 30-Jul-15 14-Sep-15 29-Sep-15 -50.00 0% 0% 0.00
DHFSH21500 Paint Final Coat 6.00 12-Aug-15 18-Aug-15 12-Oct-15 19-Oct-15 -38.00 0% 0% 0.00
Wet area 307.00 14-Aug-14 11-Aug-15 10-Aug-14 A 11-Oct-15 -50.00 10.35% 4.02% 0.39
DHFSH21140 Marking,Cutting & Chasing - Wet Area 5.00 21-Aug-14 26-Aug-14 12-Aug-14 A 24-Aug-14 A 100% 100% 1.00
DHFSH21110 Block Work in Wet Area 6.00 14-Aug-14 20-Aug-14 10-Aug-14 A 25-Aug-14 A 100% 100% 0.00
DHFSH21150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 27-Aug-14 31-Aug-14 15-Sep-14 A 21-Sep-14 A 100% 100% 1.00
DHMEP21170 Plaster in Wet Area 4.00 03-Sep-14 07-Sep-14 22-Sep-14 A 12-Oct-14 49.00 100% 13% 0.13
DHMEP21180 Wet Area Wall Tiling 6.00 04-Nov-14 11-Nov-14 10-Dec-14 16-Dec-14 1.00 0% 0% 0.00
DHFSH21300 Wet Area False Ceiling Suspension 5.00 11-Nov-14 17-Nov-14 30-Dec-14 05-Jan-15 -1.00 0% 0% 0.00
DHFSH21370 Wet Area False Ceiling Tiling/Boarding 4.00 14-Dec-14 17-Dec-14 17-Jan-15 20-Jan-15 12.00 0% 0% 0.00
DHFSH21210 Wet Area Waterproofing 4.00 18-Dec-14 22-Dec-14 21-Jan-15 25-Jan-15 12.00 0% 0% 0.00
DHFSH21220 Wet Area Floor Screed 4.00 23-Dec-14 27-Dec-14 26-Jan-15 29-Jan-15 12.00 0% 0% 0.00
DHFSH21250 Wet Area Floor Tiling 5.00 28-Dec-14 03-Jan-15 31-Jan-15 04-Feb-15 12.00 0% 0% 0.00
DHFSH06650 Cabinet Carcass 5.00 01-Feb-15 05-Feb-15 21-Feb-15 25-Feb-15 -1.00 0% 0% 0.00
DHFSH21420 Installation of Shower Enclosure 4.00 15-Jun-15 18-Jun-15 15-Aug-15 18-Aug-15 -40.00 0% 0% 0.00
DHFSH21390 Installation of Vanity Counters & Tops 5.00 17-Jun-15 22-Jun-15 17-Aug-15 22-Aug-15 -50.00 0% 0% 0.00
DHFSH21800 Installation of Kitchen Cabinet 12.00 29-Jul-15 11-Aug-15 28-Sep-15 11-Oct-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 113.00 21-Sep-14 02-May-15 27-Oct-14 09-Mar-15 78.00 0% 0% 0.00
DHFSH21240 Corridor/Lift Lobby Floor Screed 4.00 21-Sep-14 24-Sep-14 27-Oct-14 30-Oct-14 48.00 100% 0% 0.00
DHFSH21270 Lift Lobby Painting - Primer & Stucco 6.00 25-Sep-14 01-Oct-14 01-Nov-14 06-Nov-14 48.00 83.33% 0% 0.00
DHFSH21310 Lift Lobby False Ceiling Suspension 6.00 17-Nov-14 24-Nov-14 06-Jan-15 12-Jan-15 -1.00 0% 0% 0.00
DHFSH21360 Lift Lobby False Ceiling Tiling / Boarding 5.00 14-Dec-14 18-Dec-14 17-Jan-15 21-Jan-15 93.00 0% 0% 0.00
DHFSH21410 Lift Lobby Painting - 1st Coat 6.00 20-Dec-14 25-Dec-14 22-Jan-15 28-Jan-15 93.00 0% 0% 0.00
DHFSH21440 Installation of Steel Doors & Windows 3.00 29-Apr-15 02-May-15 26-Feb-15 01-Mar-15 53.00 0% 0% 0.00
DHFSH21470 Lift Lobby Flooring 6.00 04-Feb-15 10-Feb-15 24-Feb-15 02-Mar-15 78.00 0% 0% 0.00
DHFSH21490 Utility Rooms- Epoxy Flooring 6.00 11-Feb-15 17-Feb-15 03-Mar-15 09-Mar-15 78.00 0% 0% 0.00
Staircase 120.00 13-Sep-14 10-May-15 18-Oct-14 09-Mar-15 79.00 45.08% 0% 0.00
DHFSH21200 Staircase Plastering 4.00 13-Sep-14 16-Sep-14 18-Oct-14 21-Oct-14 154.00 100% 0% 0.00
DHFSH21280 Staircase Painting - Primer & Stucco 6.00 02-Oct-14 11-Oct-14 08-Nov-14 13-Nov-14 141.00 0% 0% 0.00
DHFSH21320 Staircase Handrail Fixing 3.00 27-Jan-15 31-Jan-15 09-Dec-14 11-Dec-14 140.00 0% 0% 0.00
DHFSH21330 Staircase Painting 1st Coat 3.00 31-Jan-15 03-Feb-15 28-Jan-15 31-Jan-15 101.00 0% 0% 0.00
DHFSH21340 Staircase Final Painting 5.00 03-May-15 07-May-15 02-Mar-15 07-Mar-15 79.00 0% 0% 0.00
DHFSH21380 Staircase Epoxy Flooring 2.00 09-May-15 10-May-15 08-Mar-15 09-Mar-15 79.00 0% 0% 0.00
General 341.00 20-Jul-14 12-Sep-15 22-Jul-14 A 08-Nov-15 -43.00 0% 0% 0.00
DHSTR21000 Access from Structure 0.00 20-Jul-14 22-Jul-14 A 100% 100% 0.00
DHFSH21510 Snagging & De-Snagging 12.00 30-Aug-15 12-Sep-15 26-Oct-15 08-Nov-15 -43.00 0% 0% 0.00
MEP - LEVEL 21 515.00 16-Jun-14 29-Jul-15 18-Jun-14 A 14-Nov-15 -86.00 69.55% 69.9% 1.01
DHMEP21000 Embeded Conduits & Boxex - Concrete Works 3.00 16-Jun-14 18-Jun-14 18-Jun-14 A 21-Jun-14 A 100% 100% 0.00
DHMEP21100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C20a-bJluinl-g1 4, Wiring et1c1-Aug-14 22-Jul-14 A 07-Sep-14 A 100% 100% 1.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Marking,Cutting & Chasing - Wet Area
Block Work in Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 28 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHMEP21130 Cable Trays & Cable Trunking 6.00 21-Aug-14 27-Aug-14 22-Jul-14 A 07-Sep-14 A 100% 100% 0.00
DHMEP21120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 27-Aug-14 02-Sep-14 25-Aug-14 A 22-Sep-14 A 100% 100% 1.00
DHMEP21160 Pressure Testing of Pipes 12.00 03-Sep-14 16-Sep-14 27-Aug-14 A 13-Oct-14 73.00 100% 86% 0.00
DHMEP21110 MEP Works in Risers& Clearance 6.00 11-Oct-14 16-Oct-14 18-Aug-14 A 06-Dec-14 -33.00 0% 21% 0.00
DHMEP21140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es07-Dec-14 13-Dec-14 09-Sep-14 A 15-Jan-15 -1.00 0% 12% 0.00
DHMEP21150 MEP Final Fixes 6.00 20-Jun-15 25-Jun-15 19-Aug-15 25-Aug-15 -40.00 0% 0% 0.00
DHMEP06330 Sanitary ware /Toilet accessories 6.00 23-Jun-15 29-Jun-15 23-Aug-15 29-Aug-15 -30.00 0% 0% 0.00
DHMEP21200 Pre-Testing & Commissioning 7.00 22-Jul-15 29-Jul-15 15-Sep-15 22-Sep-15 -44.00 0% 0% 0.00
DHMEP21010 Busbar - L21to L25 19.00 28-Apr-15 20-May-15 24-Oct-15 14-Nov-15 -144.00 0% 0% 0.00
LEVEL 22 513.00 12-Jun-14 19-Sep-15 07-Jun-14 A 15-Nov-15 -43.00 69.75% 67.61% 0.97
STRUCTURAL WORKS - LEVEL 22 13.00 12-Jun-14 26-Jun-14 07-Jun-14 A 30-Jun-14 A 100% 100% 1.00
DHCWA23100 Core Wall - Level 22 4.00 12-Jun-14 16-Jun-14 07-Jun-14 A 10-Jun-14 A 100% 100% 1.00
DHSLA22100 Construction of Horizontals - L22 3.00 22-Jun-14 24-Jun-14 24-Jun-14 A 27-Jun-14 A 100% 100% 1.00
DHCWA23110 Construction of Verticals - L22 2.00 25-Jun-14 26-Jun-14 28-Jun-14 A 30-Jun-14 A 100% 100% 1.00
STAIRCASES 4.00 13-Sep-14 16-Sep-14 13-Aug-14 A 26-Aug-14 A 0% 0% 0.00
A1620 Stair # 1 4.00 13-Sep-14 16-Sep-14 13-Aug-14 A 18-Aug-14 A 100% 100% 0.00
A1630 Stair # 2 3.00 14-Sep-14 16-Sep-14 23-Aug-14 A 26-Aug-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 22 347.00 27-Jul-14 19-Sep-15 27-Jul-14 A 15-Nov-15 -43.00 23.05% 13.15% 0.57
Dry area 319.00 21-Aug-14 25-Aug-15 12-Aug-14 A 26-Oct-15 -38.00 35.49% 27.7% 0.78
DHFSH22100 Block Work in Dry Area 6.00 21-Aug-14 27-Aug-14 12-Aug-14 A 25-Aug-14 A 100% 100% 1.00
DHFSH22120 Marking,Cutting & Chasing - Dry Area 4.00 28-Aug-14 01-Sep-14 01-Sep-14 A 07-Sep-14 A 100% 100% 1.00
DHFSH22130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 02-Sep-14 06-Sep-14 21-Sep-14 A 26-Sep-14 A 100% 100% 1.00
DHFSH22160 Plaster in Dry Area 8.00 09-Sep-14 17-Sep-14 28-Sep-14 A 16-Oct-14 51.00 100% 5% 0.05
DHMEP22190 Dry Area Floor Screed 7.00 18-Sep-14 25-Sep-14 18-Oct-14 26-Oct-14 51.00 100% 0% 0.00
DHFSH22230 Dry Area Painting - Primer 4.00 27-Sep-14 30-Sep-14 27-Oct-14 30-Oct-14 102.00 100% 0% 0.00
DHFSH22260 Dry Area Painting - Stucco 6.00 01-Oct-14 09-Oct-14 01-Nov-14 06-Nov-14 102.00 0% 0% 0.00
DHFSH22290 Dry Area False Ceiling Suspension 6.00 09-Nov-14 16-Nov-14 28-Dec-14 04-Jan-15 -15.00 0% 0% 0.00
DHFSH22350 Dry Area False Ceiling Tiling / Boarding 5.00 17-Dec-14 22-Dec-14 21-Jan-15 26-Jan-15 35.00 0% 0% 0.00
DHFSH22400 Dry Area Painting - 1st Coat 5.00 23-Dec-14 28-Dec-14 27-Jan-15 01-Feb-15 35.00 0% 0% 0.00
DHFSH22450 Dry Area Flooring 5.00 04-Feb-15 09-Feb-15 24-Feb-15 01-Mar-15 16.00 0% 0% 0.00
DHFSH22430 Installation of Timber Doors & Ironmongery 4.00 16-Jun-15 20-Jun-15 16-Aug-15 19-Aug-15 -50.00 0% 0% 0.00
DHFSH22802 Installation of Wardrobe 12.00 22-Jul-15 04-Aug-15 19-Sep-15 04-Oct-15 -50.00 0% 0% 0.00
DHFSH22500 Paint Final Coat 6.00 19-Aug-15 25-Aug-15 20-Oct-15 26-Oct-15 -38.00 0% 0% 0.00
Wet area 313.00 21-Aug-14 18-Aug-15 12-Aug-14 A 19-Oct-15 -50.00 10.35% 3.44% 0.33
DHFSH22110 Block Work in Wet Area 6.00 21-Aug-14 27-Aug-14 12-Aug-14 A 25-Aug-14 A 100% 100% 0.00
DHFSH22140 Marking,Cutting & Chasing - Wet Area 4.00 28-Aug-14 01-Sep-14 01-Sep-14 A 07-Sep-14 A 100% 100% 1.00
DHFSH22150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 02-Sep-14 06-Sep-14 21-Sep-14 A 26-Sep-14 A 100% 100% 1.00
DHMEP22170 Plaster in Wet Area 4.00 09-Sep-14 13-Sep-14 28-Sep-14 A 12-Oct-14 53.00 100% 5% 0.05
DHMEP22180 Wet Area Wall Tiling 6.00 09-Nov-14 16-Nov-14 15-Dec-14 21-Dec-14 1.00 0% 0% 0.00
DHFSH22300 Wet Area False Ceiling Suspension 5.00 16-Nov-14 22-Nov-14 05-Jan-15 10-Jan-15 -2.00 0% 0% 0.00
DHFSH22370 Wet Area False Ceiling Tiling/Boarding 4.00 17-Dec-14 21-Dec-14 21-Jan-15 25-Jan-15 13.00 0% 0% 0.00
DHFSH22210 Wet Area Waterproofing 4.00 22-Dec-14 25-Dec-14 26-Jan-15 29-Jan-15 13.00 0% 0% 0.00
DHFSH22220 Wet Area Floor Screed 4.00 27-Dec-14 30-Dec-14 31-Jan-15 03-Feb-15 13.00 0% 0% 0.00
DHFSH22250 Wet Area Floor Tiling 5.00 31-Dec-14 06-Jan-15 04-Feb-15 09-Feb-15 13.00 0% 0% 0.00
DHFSH06660 Cabinet Carcass 5.00 07-Feb-15 11-Feb-15 26-Feb-15 03-Mar-15 -1.00 0% 0% 0.00
DHFSH22420 Installation of Shower Enclosure 4.00 20-Jun-15 23-Jun-15 19-Aug-15 23-Aug-15 -40.00 0% 0% 0.00
DHFSH22390 Installation of Vanity Counters & Tops 5.00 22-Jun-15 27-Jun-15 22-Aug-15 26-Aug-15 -50.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Busbar - L21to L25
Core Wall - Level 22
Construction of Horizontals - L22
Construction of Verticals - L22
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 29 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH22800 Installation of Kitchen Cabinet 12.00 05-Aug-15 18-Aug-15 05-Oct-15 19-Oct-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 118.00 27-Sep-14 05-May-15 27-Oct-14 15-Mar-15 75.00 0% 0% 0.00
DHFSH22240 Corridor/Lift Lobby Floor Screed 4.00 27-Sep-14 30-Sep-14 27-Oct-14 30-Oct-14 51.00 100% 0% 0.00
DHFSH22270 Lift Lobby Painting - Primer & Stucco 6.00 01-Oct-14 09-Oct-14 01-Nov-14 06-Nov-14 51.00 0% 0% 0.00
DHFSH22310 Lift Lobby False Ceiling Suspension 6.00 22-Nov-14 29-Nov-14 11-Jan-15 17-Jan-15 -2.00 0% 0% 0.00
DHFSH22360 Lift Lobby False Ceiling Tiling / Boarding 5.00 17-Dec-14 22-Dec-14 21-Jan-15 26-Jan-15 92.00 0% 0% 0.00
DHFSH22410 Lift Lobby Painting - 1st Coat 6.00 23-Dec-14 29-Dec-14 27-Jan-15 02-Feb-15 92.00 0% 0% 0.00
DHFSH22440 Installation of Steel Doors & Windows 3.00 03-May-15 05-May-15 04-Mar-15 07-Mar-15 51.00 0% 0% 0.00
DHFSH22470 Lift Lobby Flooring 6.00 10-Feb-15 16-Feb-15 02-Mar-15 08-Mar-15 75.00 0% 0% 0.00
DHFSH22490 Utility Rooms- Epoxy Flooring 6.00 17-Feb-15 23-Feb-15 09-Mar-15 15-Mar-15 75.00 0% 0% 0.00
Staircase 125.00 18-Sep-14 13-May-15 18-Oct-14 15-Mar-15 78.00 45.08% 0% 0.00
DHFSH22200 Staircase Plastering 4.00 18-Sep-14 22-Sep-14 18-Oct-14 21-Oct-14 157.00 100% 0% 0.00
DHFSH22280 Staircase Painting - Primer & Stucco 6.00 11-Oct-14 16-Oct-14 08-Nov-14 13-Nov-14 144.00 0% 0% 0.00
DHFSH22320 Staircase Handrail Fixing 3.00 31-Jan-15 03-Feb-15 13-Dec-14 15-Dec-14 140.00 0% 0% 0.00
DHFSH22330 Staircase Painting 1st Coat 3.00 03-Feb-15 07-Feb-15 02-Feb-15 04-Feb-15 100.00 0% 0% 0.00
DHFSH22340 Staircase Final Painting 5.00 06-May-15 11-May-15 08-Mar-15 12-Mar-15 78.00 0% 0% 0.00
DHFSH22380 Staircase Epoxy Flooring 2.00 12-May-15 13-May-15 14-Mar-15 15-Mar-15 78.00 0% 0% 0.00
General 347.00 27-Jul-14 19-Sep-15 27-Jul-14 A 15-Nov-15 -43.00 0% 0% 0.00
DHSTR22000 Access from Structure 0.00 27-Jul-14 27-Jul-14 A 100% 100% 0.00
DHFSH22510 Snagging & De-Snagging 12.00 06-Sep-15 19-Sep-15 02-Nov-15 15-Nov-15 -43.00 0% 0% 0.00
MEP - LEVEL 22 476.00 22-Jun-14 05-Aug-15 24-Jun-14 A 01-Oct-15 -44.00 69.55% 69.9% 1.01
DHMEP22000 Embeded Conduits & Boxex - Concrete Works 3.00 22-Jun-14 24-Jun-14 24-Jun-14 A 27-Jun-14 A 100% 100% 0.00
DHMEP22100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C27a-bJluinl-g1 4, Wiring et1c8-Aug-14 27-Jul-14 A 09-Sep-14 A 100% 100% 1.00
DHMEP22130 Cable Trays & Cable Trunking 6.00 28-Aug-14 03-Sep-14 27-Jul-14 A 09-Sep-14 A 100% 100% 0.00
DHMEP22120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 02-Sep-14 08-Sep-14 08-Sep-14 A 17-Sep-14 A 100% 100% 1.00
DHMEP22160 Pressure Testing of Pipes 12.00 09-Sep-14 22-Sep-14 20-Aug-14 A 14-Oct-14 75.00 100% 53% 0.00
DHMEP22110 MEP Works in Risers& Clearance 6.00 18-Oct-14 23-Oct-14 19-Aug-14 A 11-Dec-14 -33.00 0% 16% 0.00
DHMEP22140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es10-Dec-14 16-Dec-14 11-Sep-14 A 20-Jan-15 -2.00 0% 12% 0.00
DHMEP22150 MEP Final Fixes 6.00 24-Jun-15 30-Jun-15 24-Aug-15 30-Aug-15 -40.00 0% 0% 0.00
DHMEP06340 Sanitary ware /Toilet accessories 6.00 28-Jun-15 04-Jul-15 27-Aug-15 02-Sep-15 -28.00 0% 0% 0.00
DHMEP22200 Pre-Testing & Commissioning 7.00 29-Jul-15 05-Aug-15 22-Sep-15 01-Oct-15 -44.00 0% 0% 0.00
LEVEL 23 516.00 17-Jun-14 28-Sep-15 12-Jun-14 A 22-Nov-15 -43.00 69.77% 67.34% 0.97
STRUCTURAL WORKS - LEVEL 23 84.00 17-Jun-14 06-Jul-14 12-Jun-14 A 08-Jul-14 A 100% 100% 1.00
DHCWA24100 Core Wall - Level 23 4.00 17-Jun-14 21-Jun-14 12-Jun-14 A 15-Jun-14 A 100% 100% 1.00
DHCWA24120 Tower Crane Jump 1.00 21-Jun-14 21-Jun-14 17-Jun-14 A 17-Jun-14 A 100% 100% 0.00
DHSLA23100 Construction of Horizontals- L23 5.00 28-Jun-14 02-Jul-14 27-Jun-14 A 04-Jul-14 A 100% 100% 1.00
DHCWA24110 Construction of Verticals - L23 3.00 03-Jul-14 06-Jul-14 04-Jul-14 A 08-Jul-14 A 100% 100% 1.00
STAIRCASES 4.00 17-Sep-14 21-Sep-14 18-Aug-14 A 23-Aug-14 A 0% 0% 0.00
A1640 Stair # 1 4.00 17-Sep-14 21-Sep-14 18-Aug-14 A 23-Aug-14 A 100% 100% 0.00
A1650 Stair # 2 3.00 18-Sep-14 21-Sep-14 18-Aug-14 A 23-Aug-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 23 353.00 04-Aug-14 28-Sep-15 04-Aug-14 A 22-Nov-15 -43.00 23.05% 11.84% 0.51
Dry area 325.00 26-Aug-14 01-Sep-15 25-Aug-14 A 02-Nov-15 -38.00 35.49% 26.13% 0.74
DHFSH23120 Marking,Cutting & Chasing - Dry Area 4.00 02-Sep-14 06-Sep-14 07-Sep-14 A 10-Sep-14 A 100% 100% 1.00
DHFSH23100 Block Work in Dry Area 6.00 26-Aug-14 01-Sep-14 25-Aug-14 A 15-Sep-14 A 100% 100% 1.00
DHFSH23130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 07-Sep-14 10-Sep-14 30-Sep-14 A 11-Oct-14 51.00 100% 50% 0.50
DHFSH23160 Plaster in Dry Area 8.00 14-Sep-14 22-Sep-14 12-Oct-14 20-Oct-14 51.00 100% 0% 0.00
DHMEP23190 Dry Area Floor Screed 7.00 23-Sep-14 30-Sep-14 21-Oct-14 29-Oct-14 51.00 100% 0% 0.00
DHFSH23230 Dry Area Painting - Primer 4.00 01-Oct-14 07-Oct-14 30-Oct-14 03-Nov-14 104.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - Level 23
Tower Crane Jump
Construction of Horizontals- L23
Construction of Verticals - L23
Stair # 1
Stair # 2
Marking,Cutting & Chasing - Dry Area
Block Work in Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 30 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH23260 Dry Area Painting - Stucco 6.00 08-Oct-14 14-Oct-14 04-Nov-14 10-Nov-14 104.00 0% 0% 0.00
DHFSH23290 Dry Area False Ceiling Suspension 6.00 13-Nov-14 20-Nov-14 12-Jan-15 19-Jan-15 -23.00 0% 0% 0.00
DHFSH23350 Dry Area False Ceiling Tiling / Boarding 5.00 21-Dec-14 25-Dec-14 04-Feb-15 10-Feb-15 28.00 0% 0% 0.00
DHFSH23400 Dry Area Painting - 1st Coat 5.00 27-Dec-14 31-Dec-14 10-Feb-15 16-Feb-15 28.00 0% 0% 0.00
DHFSH23450 Dry Area Flooring 5.00 10-Feb-15 15-Feb-15 02-Mar-15 07-Mar-15 16.00 0% 0% 0.00
DHFSH23430 Installation of Timber Doors & Ironmongery 4.00 21-Jun-15 24-Jun-15 20-Aug-15 24-Aug-15 -50.00 0% 0% 0.00
DHFSH23802 Installation of Wardrobe 12.00 29-Jul-15 11-Aug-15 28-Sep-15 11-Oct-15 -50.00 0% 0% 0.00
DHFSH23500 Paint Final Coat 6.00 26-Aug-15 01-Sep-15 27-Oct-15 02-Nov-15 -38.00 0% 0% 0.00
Wet area 319.00 26-Aug-14 25-Aug-15 25-Aug-14 A 26-Oct-15 -50.00 10.35% 2.05% 0.20
DHFSH23140 Marking,Cutting & Chasing - Wet Area 4.00 02-Sep-14 06-Sep-14 07-Sep-14 A 10-Sep-14 A 100% 100% 1.00
DHFSH23110 Block Work in Wet Area 6.00 26-Aug-14 01-Sep-14 25-Aug-14 A 15-Sep-14 A 100% 100% 0.00
DHFSH23150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 07-Sep-14 10-Sep-14 30-Sep-14 A 11-Oct-14 54.00 100% 50% 0.50
DHMEP23170 Plaster in Wet Area 4.00 14-Sep-14 17-Sep-14 12-Oct-14 15-Oct-14 54.00 100% 0% 0.00
DHMEP23180 Wet Area Wall Tiling 6.00 13-Nov-14 20-Nov-14 20-Dec-14 25-Dec-14 1.00 0% 0% 0.00
DHFSH23300 Wet Area False Ceiling Suspension 5.00 20-Nov-14 26-Nov-14 19-Jan-15 25-Jan-15 -11.00 0% 0% 0.00
DHFSH23370 Wet Area False Ceiling Tiling/Boarding 4.00 21-Dec-14 24-Dec-14 04-Feb-15 09-Feb-15 6.00 0% 0% 0.00
DHFSH23210 Wet Area Waterproofing 4.00 25-Dec-14 29-Dec-14 09-Feb-15 14-Feb-15 6.00 0% 0% 0.00
DHFSH23220 Wet Area Floor Screed 4.00 30-Dec-14 04-Jan-15 14-Feb-15 18-Feb-15 6.00 0% 0% 0.00
DHFSH23250 Wet Area Floor Tiling 5.00 05-Jan-15 10-Jan-15 18-Feb-15 24-Feb-15 6.00 0% 0% 0.00
DHFSH06670 Cabinet Carcass 5.00 12-Feb-15 17-Feb-15 04-Mar-15 09-Mar-15 -1.00 0% 0% 0.00
DHFSH23420 Installation of Shower Enclosure 4.00 24-Jun-15 28-Jun-15 24-Aug-15 27-Aug-15 -41.00 0% 0% 0.00
DHFSH23390 Installation of Vanity Counters & Tops 5.00 27-Jun-15 01-Jul-15 26-Aug-15 31-Aug-15 -50.00 0% 0% 0.00
DHFSH23800 Installation of Kitchen Cabinet 12.00 12-Aug-15 25-Aug-15 12-Oct-15 26-Oct-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 120.00 01-Oct-14 09-May-15 30-Oct-14 21-Mar-15 72.00 0% 0% 0.00
DHFSH23240 Corridor/Lift Lobby Floor Screed 4.00 01-Oct-14 07-Oct-14 30-Oct-14 03-Nov-14 51.00 0% 0% 0.00
DHFSH23270 Lift Lobby Painting - Primer & Stucco 6.00 08-Oct-14 14-Oct-14 04-Nov-14 10-Nov-14 51.00 0% 0% 0.00
DHFSH23310 Lift Lobby False Ceiling Suspension 6.00 26-Nov-14 04-Dec-14 25-Jan-15 01-Feb-15 -11.00 0% 0% 0.00
DHFSH23360 Lift Lobby False Ceiling Tiling / Boarding 5.00 21-Dec-14 25-Dec-14 04-Feb-15 10-Feb-15 83.00 0% 0% 0.00
DHFSH23410 Lift Lobby Painting - 1st Coat 6.00 27-Dec-14 03-Jan-15 10-Feb-15 17-Feb-15 83.00 0% 0% 0.00
DHFSH23440 Installation of Steel Doors & Windows 3.00 06-May-15 09-May-15 10-Mar-15 12-Mar-15 49.00 0% 0% 0.00
DHFSH23470 Lift Lobby Flooring 6.00 16-Feb-15 22-Feb-15 08-Mar-15 14-Mar-15 72.00 0% 0% 0.00
DHFSH23490 Utility Rooms- Epoxy Flooring 6.00 23-Feb-15 01-Mar-15 15-Mar-15 21-Mar-15 72.00 0% 0% 0.00
Staircase 127.00 23-Sep-14 18-May-15 21-Oct-14 21-Mar-15 77.00 45.08% 0% 0.00
DHFSH23200 Staircase Plastering 4.00 23-Sep-14 27-Sep-14 21-Oct-14 26-Oct-14 157.00 100% 0% 0.00
DHFSH23280 Staircase Painting - Primer & Stucco 6.00 15-Oct-14 21-Oct-14 11-Nov-14 17-Nov-14 144.00 0% 0% 0.00
DHFSH23320 Staircase Handrail Fixing 3.00 03-Feb-15 07-Feb-15 16-Dec-14 18-Dec-14 140.00 0% 0% 0.00
DHFSH23330 Staircase Painting 1st Coat 3.00 07-Feb-15 10-Feb-15 16-Feb-15 19-Feb-15 91.00 0% 0% 0.00
DHFSH23340 Staircase Final Painting 5.00 10-May-15 14-May-15 14-Mar-15 18-Mar-15 77.00 0% 0% 0.00
DHFSH23380 Staircase Epoxy Flooring 2.00 17-May-15 18-May-15 19-Mar-15 21-Mar-15 77.00 0% 0% 0.00
General 353.00 04-Aug-14 28-Sep-15 04-Aug-14 A 22-Nov-15 -43.00 0% 0% 0.00
DHSTR23000 Access from Structure 0.00 04-Aug-14 04-Aug-14 A 100% 100% 0.00
DHFSH23510 Snagging & De-Snagging 12.00 13-Sep-15 28-Sep-15 09-Nov-15 22-Nov-15 -43.00 0% 0% 0.00
MEP - LEVEL 23 479.00 30-Jun-14 12-Aug-15 27-Jun-14 A 08-Oct-15 -44.00 69.55% 69.9% 1.01
DHMEP23000 Embeded Conduits & Boxex - Concrete Works 3.00 30-Jun-14 02-Jul-14 27-Jun-14 A 04-Jul-14 A 100% 100% 0.00
DHMEP23100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C04a-bAliungg- 1, 4Wiring et2c4-Aug-14 04-Aug-14 A 13-Sep-14 A 100% 100% 1.00
DHMEP23130 Cable Trays & Cable Trunking 6.00 02-Sep-14 08-Sep-14 04-Aug-14 A 13-Sep-14 A 100% 100% 0.00
DHMEP23120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 07-Sep-14 13-Sep-14 11-Sep-14 A 29-Sep-14 A 100% 100% 1.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Marking,Cutting & Chasing - Wet Area
Block Work in Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 31 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHMEP23160 Pressure Testing of Pipes 12.00 14-Sep-14 27-Sep-14 30-Aug-14 A 14-Oct-14 78.00 100% 66% 0.00
DHMEP23110 MEP Works in Risers& Clearance 6.00 26-Oct-14 01-Nov-14 20-Aug-14 A 17-Dec-14 -33.00 0% 12% 0.00
DHMEP23140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es14-Dec-14 20-Dec-14 14-Sep-14 A 04-Feb-15 -11.00 0% 12% 0.00
DHMEP23150 MEP Final Fixes 6.00 29-Jun-15 05-Jul-15 29-Aug-15 03-Sep-15 -41.00 0% 0% 0.00
DHMEP06350 Sanitary ware /Toilet accessories 6.00 02-Jul-15 08-Jul-15 01-Sep-15 07-Sep-15 -26.00 0% 0% 0.00
DHMEP23200 Pre-Testing & Commissioning 7.00 05-Aug-15 12-Aug-15 01-Oct-15 08-Oct-15 -44.00 0% 0% 0.00
LEVEL 24 519.00 22-Jun-14 05-Oct-15 17-Jun-14 A 29-Nov-15 -43.00 69.45% 61.38% 0.88
STRUCTURAL WORKS - LEVEL 24 20.00 22-Jun-14 14-Jul-14 17-Jun-14 A 14-Jul-14 A 100% 100% 1.00
DHCWA25100 Core Wall - Level 24 8.00 22-Jun-14 30-Jun-14 17-Jun-14 A 19-Jun-14 A 100% 100% 1.00
DHSLA24100 Construction of Horizontals - L24 4.00 07-Jul-14 10-Jul-14 04-Jul-14 A 10-Jul-14 A 100% 100% 1.00
DHCWA25110 Construction of Verticals - L24 3.00 12-Jul-14 14-Jul-14 10-Jul-14 A 14-Jul-14 A 100% 100% 1.00
STAIRCASES 4.00 22-Sep-14 25-Sep-14 24-Aug-14 A 30-Aug-14 A 0% 0% 0.00
A1660 Stair # 1 4.00 22-Sep-14 25-Sep-14 24-Aug-14 A 30-Aug-14 A 100% 100% 0.00
A1670 Stair # 2 3.00 23-Sep-14 25-Sep-14 24-Aug-14 A 30-Aug-14 A 100% 100% 0.00
FINISHES WORKS - LEVEL 24 359.00 10-Aug-14 05-Oct-15 10-Aug-14 A 29-Nov-15 -43.00 21.35% 10.88% 0.51
Dry area 331.00 01-Sep-14 08-Sep-15 28-Aug-14 A 09-Nov-15 -38.00 35.49% 24.98% 0.70
DHFSH24120 Marking,Cutting & Chasing - Dry Area 4.00 08-Sep-14 11-Sep-14 11-Sep-14 A 15-Sep-14 A 100% 100% 1.00
DHFSH24100 Block Work in Dry Area 6.00 01-Sep-14 07-Sep-14 28-Aug-14 A 21-Sep-14 A 100% 100% 1.00
DHFSH24130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 13-Sep-14 16-Sep-14 09-Oct-14 13-Oct-14 52.00 100% 0% 0.00
DHFSH24160 Plaster in Dry Area 8.00 20-Sep-14 28-Sep-14 14-Oct-14 22-Oct-14 52.00 100% 0% 0.00
DHMEP24190 Dry Area Floor Screed 7.00 29-Sep-14 08-Oct-14 23-Oct-14 01-Nov-14 52.00 28.57% 0% 0.00
DHFSH24230 Dry Area Painting - Primer 4.00 09-Oct-14 13-Oct-14 02-Nov-14 05-Nov-14 107.00 0% 0% 0.00
DHFSH24260 Dry Area Painting - Stucco 6.00 14-Oct-14 20-Oct-14 06-Nov-14 12-Nov-14 107.00 0% 0% 0.00
DHFSH24290 Dry Area False Ceiling Suspension 6.00 18-Nov-14 25-Nov-14 17-Jan-15 24-Jan-15 -23.00 0% 0% 0.00
DHFSH24350 Dry Area False Ceiling Tiling / Boarding 5.00 24-Dec-14 29-Dec-14 09-Feb-15 15-Feb-15 29.00 0% 0% 0.00
DHFSH24400 Dry Area Painting - 1st Coat 5.00 30-Dec-14 05-Jan-15 15-Feb-15 21-Feb-15 29.00 0% 0% 0.00
DHFSH24450 Dry Area Flooring 5.00 16-Feb-15 21-Feb-15 08-Mar-15 12-Mar-15 16.00 0% 0% 0.00
DHFSH24430 Installation of Timber Doors & Ironmongery 4.00 25-Jun-15 29-Jun-15 25-Aug-15 29-Aug-15 -50.00 0% 0% 0.00
DHFSH24802 Installation of Wardrobe 12.00 05-Aug-15 18-Aug-15 05-Oct-15 19-Oct-15 -50.00 0% 0% 0.00
DHFSH24500 Paint Final Coat 6.00 02-Sep-15 08-Sep-15 03-Nov-15 09-Nov-15 -38.00 0% 0% 0.00
Wet area 325.00 01-Sep-14 01-Sep-15 28-Aug-14 A 02-Nov-15 -50.00 10.35% 1.03% 0.10
DHFSH24140 Marking,Cutting & Chasing - Wet Area 4.00 08-Sep-14 11-Sep-14 11-Sep-14 A 15-Sep-14 A 100% 100% 1.00
DHFSH24110 Block Work in Wet Area 6.00 01-Sep-14 07-Sep-14 28-Aug-14 A 21-Sep-14 A 100% 100% 0.00
DHFSH24150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 13-Sep-14 16-Sep-14 09-Oct-14 13-Oct-14 56.00 100% 0% 0.00
DHMEP24170 Plaster in Wet Area 4.00 20-Sep-14 23-Sep-14 14-Oct-14 18-Oct-14 56.00 100% 0% 0.00
DHMEP24180 Wet Area Wall Tiling 6.00 18-Nov-14 25-Nov-14 24-Dec-14 30-Dec-14 1.00 0% 0% 0.00
DHFSH24300 Wet Area False Ceiling Suspension 5.00 25-Nov-14 01-Dec-14 24-Jan-15 29-Jan-15 -12.00 0% 0% 0.00
DHFSH24370 Wet Area False Ceiling Tiling/Boarding 4.00 24-Dec-14 28-Dec-14 09-Feb-15 14-Feb-15 7.00 0% 0% 0.00
DHFSH24210 Wet Area Waterproofing 4.00 29-Dec-14 03-Jan-15 14-Feb-15 18-Feb-15 7.00 0% 0% 0.00
DHFSH24220 Wet Area Floor Screed 4.00 04-Jan-15 07-Jan-15 18-Feb-15 23-Feb-15 7.00 0% 0% 0.00
DHFSH24250 Wet Area Floor Tiling 5.00 08-Jan-15 13-Jan-15 23-Feb-15 01-Mar-15 7.00 0% 0% 0.00
DHFSH06680 Cabinet Carcass 5.00 18-Feb-15 23-Feb-15 10-Mar-15 15-Mar-15 -1.00 0% 0% 0.00
DHFSH24420 Installation of Shower Enclosure 4.00 29-Jun-15 02-Jul-15 29-Aug-15 01-Sep-15 -42.00 0% 0% 0.00
DHFSH24390 Installation of Vanity Counters & Tops 5.00 01-Jul-15 06-Jul-15 31-Aug-15 05-Sep-15 -50.00 0% 0% 0.00
DHFSH24800 Installation of Kitchen Cabinet 12.00 19-Aug-15 01-Sep-15 20-Oct-15 02-Nov-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 123.00 09-Oct-14 12-May-15 02-Nov-14 26-Mar-15 69.00 0% 0% 0.00
DHFSH24240 Corridor/Lift Lobby Floor Screed 4.00 09-Oct-14 13-Oct-14 02-Nov-14 05-Nov-14 52.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - Level 24
Construction of Horizontals - L24
Construction of Verticals - L24
Stair # 1
Stair # 2
Marking,Cutting & Chasing - Dry Area
Block Work in Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Marking,Cutting & Chasing - Wet Area
Block Work in Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 32 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH24270 Lift Lobby Painting - Primer & Stucco 6.00 14-Oct-14 20-Oct-14 06-Nov-14 12-Nov-14 52.00 0% 0% 0.00
DHFSH24310 Lift Lobby False Ceiling Suspension 6.00 01-Dec-14 09-Dec-14 29-Jan-15 05-Feb-15 -12.00 0% 0% 0.00
DHFSH24360 Lift Lobby False Ceiling Tiling / Boarding 5.00 24-Dec-14 29-Dec-14 09-Feb-15 15-Feb-15 82.00 0% 0% 0.00
DHFSH24410 Lift Lobby Painting - 1st Coat 6.00 30-Dec-14 06-Jan-15 15-Feb-15 22-Feb-15 82.00 0% 0% 0.00
DHFSH24440 Installation of Steel Doors & Windows 3.00 10-May-15 12-May-15 16-Mar-15 18-Mar-15 47.00 0% 0% 0.00
DHFSH24470 Lift Lobby Flooring 6.00 22-Feb-15 28-Feb-15 14-Mar-15 19-Mar-15 69.00 0% 0% 0.00
DHFSH24490 Utility Rooms- Epoxy Flooring 6.00 01-Mar-15 07-Mar-15 21-Mar-15 26-Mar-15 69.00 0% 0% 0.00
Staircase 130.00 29-Sep-14 21-May-15 23-Oct-14 26-Mar-15 76.00 22.54% 0% 0.00
DHFSH24200 Staircase Plastering 4.00 29-Sep-14 02-Oct-14 23-Oct-14 28-Oct-14 158.00 50% 0% 0.00
DHFSH24280 Staircase Painting - Primer & Stucco 6.00 21-Oct-14 28-Oct-14 13-Nov-14 19-Nov-14 145.00 0% 0% 0.00
DHFSH24320 Staircase Handrail Fixing 3.00 07-Feb-15 10-Feb-15 20-Dec-14 22-Dec-14 140.00 0% 0% 0.00
DHFSH24330 Staircase Painting 1st Coat 3.00 10-Feb-15 14-Feb-15 21-Feb-15 24-Feb-15 90.00 0% 0% 0.00
DHFSH24340 Staircase Final Painting 5.00 13-May-15 19-May-15 19-Mar-15 24-Mar-15 76.00 0% 0% 0.00
DHFSH24380 Staircase Epoxy Flooring 2.00 20-May-15 21-May-15 25-Mar-15 26-Mar-15 76.00 0% 0% 0.00
General 359.00 10-Aug-14 05-Oct-15 10-Aug-14 A 29-Nov-15 -43.00 0% 0% 0.00
DHSTR24000 Access from Structure 0.00 10-Aug-14 10-Aug-14 A 100% 100% 0.00
DHFSH24510 Snagging & De-Snagging 12.00 20-Sep-15 05-Oct-15 16-Nov-15 29-Nov-15 -43.00 0% 0% 0.00
MEP - LEVEL 24 482.00 08-Jul-14 19-Aug-15 04-Jul-14 A 17-Oct-15 -44.00 69.55% 55.73% 0.80
DHMEP24000 Embeded Conduits & Boxex - Concrete Works 3.00 08-Jul-14 10-Jul-14 04-Jul-14 A 10-Jul-14 A 100% 100% 0.00
DHMEP24100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C10a-bAliungg- 1, 4Wiring et3c0-Aug-14 10-Aug-14 A 14-Sep-14 A 100% 100% 1.00
DHMEP24130 Cable Trays & Cable Trunking 6.00 08-Sep-14 14-Sep-14 10-Aug-14 A 14-Sep-14 A 100% 100% 0.00
DHMEP24120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 13-Sep-14 18-Sep-14 16-Sep-14 A 12-Oct-14 53.00 100% 59% 0.59
DHMEP24160 Pressure Testing of Pipes 12.00 20-Sep-14 02-Oct-14 30-Aug-14 A 18-Oct-14 78.00 83.33% 66% 0.00
DHMEP24110 MEP Works in Risers& Clearance 6.00 02-Nov-14 08-Nov-14 24-Aug-14 A 23-Dec-14 -33.00 0% 12% 0.00
DHMEP24140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es17-Dec-14 23-Dec-14 16-Sep-14 A 09-Feb-15 -12.00 0% 12% 0.00
DHMEP24150 MEP Final Fixes 6.00 04-Jul-15 09-Jul-15 02-Sep-15 08-Sep-15 -42.00 0% 0% 0.00
DHMEP06360 Sanitary ware /Toilet accessories 6.00 07-Jul-15 13-Jul-15 06-Sep-15 12-Sep-15 -24.00 0% 0% 0.00
DHMEP24200 Pre-Testing & Commissioning 7.00 12-Aug-15 19-Aug-15 08-Oct-15 17-Oct-15 -44.00 0% 0% 0.00
LEVEL 25 534.00 01-Jul-14 12-Oct-15 21-Jun-14 A 07-Dec-15 -43.00 68.79% 52.75% 0.77
STRUCTURAL WORKS - LEVEL 25 18.00 01-Jul-14 21-Jul-14 21-Jun-14 A 19-Jul-14 A 100% 100% 1.00
DHCWA26100 Core Wall - Level 25 5.00 01-Jul-14 06-Jul-14 21-Jun-14 A 26-Jun-14 A 100% 100% 1.00
DHSLA25100 Construction of Horizontals - L25 4.00 15-Jul-14 19-Jul-14 10-Jul-14 A 17-Jul-14 A 100% 100% 1.00
DHCWA26110 Construction of Verticals - L25 2.00 20-Jul-14 21-Jul-14 17-Jul-14 A 19-Jul-14 A 100% 100% 1.00
STAIRCASES 4.00 28-Sep-14 01-Oct-14 01-Sep-14 A 04-Sep-14 A 0% 0% 0.00
A1680 Stair # 1 4.00 28-Sep-14 01-Oct-14 01-Sep-14 A 04-Sep-14 A 75% 100% 0.00
A1690 Stair # 2 3.00 29-Sep-14 01-Oct-14 01-Sep-14 A 04-Sep-14 A 66.67% 100% 0.00
FINISHES WORKS - LEVEL 25 365.00 17-Aug-14 12-Oct-15 13-Aug-14 A 07-Dec-15 -43.00 18.36% 9.92% 0.54
Dry area 337.00 07-Sep-14 15-Sep-15 30-Aug-14 A 16-Nov-15 -38.00 32.42% 23.82% 0.73
DHFSH25100 Block Work in Dry Area 6.00 07-Sep-14 13-Sep-14 30-Aug-14 A 27-Sep-14 A 100% 100% 1.00
DHFSH25120 Marking,Cutting & Chasing - Dry Area 4.00 14-Sep-14 17-Sep-14 09-Oct-14 13-Oct-14 50.00 100% 0% 0.00
DHFSH25130 Sub frame Fixing/Plaster Preparation - Dry Area 5.00 18-Sep-14 23-Sep-14 14-Oct-14 19-Oct-14 51.00 100% 0% 0.00
DHFSH25160 Plaster in Dry Area 8.00 25-Sep-14 06-Oct-14 21-Oct-14 30-Oct-14 50.00 62.5% 0% 0.00
DHMEP25190 Dry Area Floor Screed 7.00 07-Oct-14 14-Oct-14 01-Nov-14 08-Nov-14 50.00 0% 0% 0.00
DHFSH25230 Dry Area Painting - Primer 4.00 15-Oct-14 19-Oct-14 09-Nov-14 12-Nov-14 106.00 0% 0% 0.00
DHFSH25260 Dry Area Painting - Stucco 6.00 20-Oct-14 27-Oct-14 13-Nov-14 19-Nov-14 106.00 0% 0% 0.00
DHFSH25290 Dry Area False Ceiling Suspension 6.00 23-Nov-14 30-Nov-14 21-Jan-15 28-Jan-15 -23.00 0% 0% 0.00
DHFSH25350 Dry Area False Ceiling Tiling / Boarding 5.00 31-Dec-14 06-Jan-15 16-Feb-15 22-Feb-15 28.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - Level 25
Construction of Horizontals - L25
Construction of Verticals - L25
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 33 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH25400 Dry Area Painting - 1st Coat 5.00 07-Jan-15 12-Jan-15 22-Feb-15 28-Feb-15 28.00 0% 0% 0.00
DHFSH25450 Dry Area Flooring 5.00 22-Feb-15 26-Feb-15 14-Mar-15 18-Mar-15 16.00 0% 0% 0.00
DHFSH25430 Installation of Timber Doors & Ironmongery 4.00 30-Jun-15 04-Jul-15 30-Aug-15 02-Sep-15 -50.00 0% 0% 0.00
DHFSH25802 Installation of Wardrobe 12.00 12-Aug-15 25-Aug-15 12-Oct-15 26-Oct-15 -50.00 0% 0% 0.00
DHFSH25500 Paint Final Coat 6.00 09-Sep-15 15-Sep-15 10-Nov-15 16-Nov-15 -38.00 0% 0% 0.00
Wet area 331.00 07-Sep-14 08-Sep-15 30-Aug-14 A 09-Nov-15 -50.00 10.35% 0% 0.00
DHFSH25110 Block Work in Wet Area 6.00 07-Sep-14 13-Sep-14 30-Aug-14 A 27-Sep-14 A 100% 100% 0.00
DHFSH25140 Marking,Cutting & Chasing - Wet Area 4.00 14-Sep-14 17-Sep-14 09-Oct-14 13-Oct-14 50.00 100% 0% 0.00
DHFSH25150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 18-Sep-14 22-Sep-14 14-Oct-14 18-Oct-14 56.00 100% 0% 0.00
DHMEP25170 Plaster in Wet Area 4.00 25-Sep-14 29-Sep-14 21-Oct-14 26-Oct-14 54.00 100% 0% 0.00
DHMEP25180 Wet Area Wall Tiling 6.00 23-Nov-14 30-Nov-14 29-Dec-14 05-Jan-15 1.00 0% 0% 0.00
DHFSH25300 Wet Area False Ceiling Suspension 5.00 30-Nov-14 07-Dec-14 28-Jan-15 03-Feb-15 -12.00 0% 0% 0.00
DHFSH25370 Wet Area False Ceiling Tiling/Boarding 4.00 31-Dec-14 05-Jan-15 16-Feb-15 21-Feb-15 6.00 0% 0% 0.00
DHFSH25210 Wet Area Waterproofing 4.00 06-Jan-15 10-Jan-15 21-Feb-15 25-Feb-15 6.00 0% 0% 0.00
DHFSH25220 Wet Area Floor Screed 4.00 11-Jan-15 14-Jan-15 25-Feb-15 02-Mar-15 6.00 0% 0% 0.00
DHFSH25250 Wet Area Floor Tiling 5.00 15-Jan-15 20-Jan-15 02-Mar-15 08-Mar-15 6.00 0% 0% 0.00
DHFSH06690 Cabinet Carcass 5.00 24-Feb-15 01-Mar-15 16-Mar-15 21-Mar-15 -1.00 0% 0% 0.00
DHFSH25420 Installation of Shower Enclosure 4.00 04-Jul-15 07-Jul-15 02-Sep-15 06-Sep-15 -43.00 0% 0% 0.00
DHFSH25390 Installation of Vanity Counters & Tops 5.00 06-Jul-15 11-Jul-15 05-Sep-15 09-Sep-15 -50.00 0% 0% 0.00
DHFSH25800 Installation of Kitchen Cabinet 12.00 26-Aug-15 08-Sep-15 27-Oct-15 09-Nov-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 122.00 15-Oct-14 17-May-15 09-Nov-14 01-Apr-15 66.00 0% 0% 0.00
DHFSH25240 Corridor/Lift Lobby Floor Screed 4.00 15-Oct-14 19-Oct-14 09-Nov-14 12-Nov-14 50.00 0% 0% 0.00
DHFSH25270 Lift Lobby Painting - Primer & Stucco 6.00 20-Oct-14 27-Oct-14 13-Nov-14 19-Nov-14 50.00 0% 0% 0.00
DHFSH25310 Lift Lobby False Ceiling Suspension 6.00 07-Dec-14 14-Dec-14 03-Feb-15 10-Feb-15 -12.00 0% 0% 0.00
DHFSH25360 Lift Lobby False Ceiling Tiling / Boarding 5.00 31-Dec-14 06-Jan-15 16-Feb-15 22-Feb-15 79.00 0% 0% 0.00
DHFSH25410 Lift Lobby Painting - 1st Coat 6.00 07-Jan-15 13-Jan-15 22-Feb-15 01-Mar-15 79.00 0% 0% 0.00
DHFSH25440 Installation of Steel Doors & Windows 3.00 13-May-15 17-May-15 22-Mar-15 24-Mar-15 45.00 0% 0% 0.00
DHFSH25470 Lift Lobby Flooring 6.00 28-Feb-15 05-Mar-15 19-Mar-15 25-Mar-15 66.00 0% 0% 0.00
DHFSH25490 Utility Rooms- Epoxy Flooring 6.00 07-Mar-15 12-Mar-15 26-Mar-15 01-Apr-15 66.00 0% 0% 0.00
Staircase 129.00 07-Oct-14 25-May-15 01-Nov-14 01-Apr-15 75.00 0% 0% 0.00
DHFSH25200 Staircase Plastering 4.00 07-Oct-14 11-Oct-14 01-Nov-14 04-Nov-14 155.00 0% 0% 0.00
DHFSH25280 Staircase Painting - Primer & Stucco 6.00 28-Oct-14 03-Nov-14 20-Nov-14 26-Nov-14 142.00 0% 0% 0.00
DHFSH25320 Staircase Handrail Fixing 3.00 10-Feb-15 14-Feb-15 23-Dec-14 25-Dec-14 140.00 0% 0% 0.00
DHFSH25330 Staircase Painting 1st Coat 3.00 14-Feb-15 17-Feb-15 28-Feb-15 03-Mar-15 87.00 0% 0% 0.00
DHFSH25340 Staircase Final Painting 5.00 18-May-15 23-May-15 25-Mar-15 30-Mar-15 75.00 0% 0% 0.00
DHFSH25380 Staircase Epoxy Flooring 2.00 24-May-15 25-May-15 31-Mar-15 01-Apr-15 75.00 0% 0% 0.00
General 365.00 17-Aug-14 12-Oct-15 13-Aug-14 A 07-Dec-15 -43.00 0% 0% 0.00
DHSTR25000 Access from Structure 0.00 17-Aug-14 13-Aug-14 A 100% 100% 0.00
DHFSH25510 Snagging & De-Snagging 12.00 29-Sep-15 12-Oct-15 23-Nov-15 07-Dec-15 -43.00 0% 0% 0.00
MEP - LEVEL 25 494.00 16-Jul-14 23-Aug-15 10-Jul-14 A 20-Oct-15 -44.00 69.55% 35.09% 0.50
DHMEP25000 Embeded Conduits & Boxex - Concrete Works 3.00 16-Jul-14 19-Jul-14 10-Jul-14 A 17-Jul-14 A 100% 100% 0.00
DHMEP25100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C17a-bAliungg- 1, 4Wiring et0c6-Sep-14 13-Aug-14 A 18-Sep-14 A 100% 100% 1.00
DHMEP25130 Cable Trays & Cable Trunking 6.00 14-Sep-14 20-Sep-14 13-Aug-14 A 18-Sep-14 A 100% 100% 0.00
DHMEP25120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 18-Sep-14 24-Sep-14 14-Oct-14 20-Oct-14 50.00 100% 0% 0.00
DHMEP25160 Pressure Testing of Pipes 12.00 25-Sep-14 11-Oct-14 09-Sep-14 A 30-Oct-14 74.00 41.67% 33% 0.00
DHMEP25110 MEP Works in Risers& Clearance 6.00 09-Nov-14 15-Nov-14 30-Aug-14 A 29-Dec-14 -33.00 0% 12% 0.00
DHMEP25140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es24-Dec-14 30-Dec-14 17-Sep-14 A 16-Feb-15 -12.00 0% 4% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 34 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHMEP25150 MEP Final Fixes 6.00 08-Jul-15 14-Jul-15 07-Sep-15 13-Sep-15 -43.00 0% 0% 0.00
DHMEP06370 Sanitary ware /Toilet accessories 6.00 12-Jul-15 20-Jul-15 10-Sep-15 16-Sep-15 -25.00 0% 0% 0.00
DHMEP25200 Pre-Testing & Commissioning 7.00 16-Aug-15 23-Aug-15 12-Oct-15 20-Oct-15 -44.00 0% 0% 0.00
LEVEL 26 540.00 07-Jul-14 20-Oct-15 27-Jun-14 A 14-Dec-15 -43.00 65.18% 52.74% 0.81
STRUCTURAL WORKS - LEVEL 26 19.00 07-Jul-14 30-Jul-14 27-Jun-14 A 26-Jul-14 A 100% 100% 1.00
DHCWA27100 Core Wall - Level 26 6.00 07-Jul-14 13-Jul-14 27-Jun-14 A 03-Jul-14 A 100% 100% 1.00
DHSLA26100 Construction of Horizontals - L26 4.00 22-Jul-14 26-Jul-14 17-Jul-14 A 23-Jul-14 A 100% 100% 1.00
DHCWA27110 Construction of Verticals - L26 2.00 27-Jul-14 30-Jul-14 22-Jul-14 A 26-Jul-14 A 100% 100% 1.00
STAIRCASES 4.00 06-Oct-14 09-Oct-14 05-Sep-14 A 08-Sep-14 A 0% 0% 0.00
A1700 Stair # 1 4.00 06-Oct-14 09-Oct-14 05-Sep-14 A 08-Sep-14 A 0% 100% 0.00
A1710 Stair # 2 3.00 07-Oct-14 09-Oct-14 05-Sep-14 A 08-Sep-14 A 0% 100% 0.00
FINISHES WORKS - LEVEL 26 371.00 24-Aug-14 20-Oct-15 19-Aug-14 A 14-Dec-15 -43.00 12.81% 9.92% 0.77
Dry area 343.00 14-Sep-14 22-Sep-15 08-Sep-14 A 23-Nov-15 -38.00 27.29% 23.82% 0.87
DHFSH26100 Block Work in Dry Area 6.00 14-Sep-14 20-Sep-14 08-Sep-14 A 29-Sep-14 A 100% 100% 1.00
DHFSH26120 Marking,Cutting & Chasing - Dry Area 4.00 21-Sep-14 24-Sep-14 09-Oct-14 13-Oct-14 53.00 100% 0% 0.00
DHFSH26130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 25-Sep-14 29-Sep-14 14-Oct-14 18-Oct-14 55.00 100% 0% 0.00
DHFSH26160 Plaster in Dry Area 8.00 02-Oct-14 13-Oct-14 21-Oct-14 30-Oct-14 53.00 0% 0% 0.00
DHMEP26190 Dry Area Floor Screed 7.00 14-Oct-14 21-Oct-14 01-Nov-14 08-Nov-14 53.00 0% 0% 0.00
DHFSH26230 Dry Area Painting - Primer 4.00 22-Oct-14 27-Oct-14 09-Nov-14 12-Nov-14 109.00 0% 0% 0.00
DHFSH26260 Dry Area Painting - Stucco 6.00 28-Oct-14 03-Nov-14 13-Nov-14 19-Nov-14 109.00 0% 0% 0.00
DHFSH26290 Dry Area False Ceiling Suspension 6.00 27-Nov-14 06-Dec-14 26-Jan-15 02-Feb-15 -23.00 0% 0% 0.00
DHFSH26350 Dry Area False Ceiling Tiling / Boarding 5.00 05-Jan-15 10-Jan-15 19-Feb-15 25-Feb-15 28.00 0% 0% 0.00
DHFSH26400 Dry Area Painting - 1st Coat 5.00 11-Jan-15 15-Jan-15 25-Feb-15 03-Mar-15 28.00 0% 0% 0.00
DHFSH26450 Dry Area Flooring 5.00 28-Feb-15 04-Mar-15 19-Mar-15 24-Mar-15 16.00 0% 0% 0.00
DHFSH26430 Installation of Timber Doors & Ironmongery 4.00 05-Jul-15 08-Jul-15 03-Sep-15 07-Sep-15 -50.00 0% 0% 0.00
DHFSH26802 Installation of Wardrobe 12.00 19-Aug-15 01-Sep-15 20-Oct-15 02-Nov-15 -50.00 0% 0% 0.00
DHFSH26500 Paint Final Coat 6.00 16-Sep-15 22-Sep-15 17-Nov-15 23-Nov-15 -38.00 0% 0% 0.00
Wet area 337.00 14-Sep-14 15-Sep-15 08-Sep-14 A 16-Nov-15 -50.00 3.08% 0% 0.00
DHFSH26110 Block Work in Wet Area 6.00 14-Sep-14 20-Sep-14 08-Sep-14 A 29-Sep-14 A 100% 100% 0.00
DHFSH26140 Marking,Cutting & Chasing - Wet Area 4.00 21-Sep-14 24-Sep-14 09-Oct-14 13-Oct-14 53.00 100% 0% 0.00
DHFSH26150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 25-Sep-14 29-Sep-14 14-Oct-14 18-Oct-14 60.00 100% 0% 0.00
DHMEP26170 Plaster in Wet Area 4.00 02-Oct-14 08-Oct-14 21-Oct-14 26-Oct-14 58.00 0% 0% 0.00
DHMEP26180 Wet Area Wall Tiling 6.00 27-Nov-14 06-Dec-14 04-Jan-15 10-Jan-15 1.00 0% 0% 0.00
DHFSH26300 Wet Area False Ceiling Suspension 5.00 06-Dec-14 11-Dec-14 02-Feb-15 08-Feb-15 -13.00 0% 0% 0.00
DHFSH26370 Wet Area False Ceiling Tiling/Boarding 4.00 05-Jan-15 08-Jan-15 19-Feb-15 24-Feb-15 8.00 0% 0% 0.00
DHFSH26210 Wet Area Waterproofing 4.00 10-Jan-15 13-Jan-15 24-Feb-15 01-Mar-15 8.00 0% 0% 0.00
DHFSH26220 Wet Area Floor Screed 4.00 14-Jan-15 18-Jan-15 01-Mar-15 05-Mar-15 8.00 0% 0% 0.00
DHFSH26250 Wet Area Floor Tiling 5.00 19-Jan-15 24-Jan-15 05-Mar-15 11-Mar-15 8.00 0% 0% 0.00
DHFSH06700 Cabinet Carcass 5.00 02-Mar-15 07-Mar-15 22-Mar-15 26-Mar-15 -1.00 0% 0% 0.00
DHFSH26420 Installation of Shower Enclosure 4.00 08-Jul-15 12-Jul-15 07-Sep-15 10-Sep-15 -44.00 0% 0% 0.00
DHFSH26390 Installation of Vanity Counters & Tops 5.00 11-Jul-15 15-Jul-15 09-Sep-15 14-Sep-15 -50.00 0% 0% 0.00
DHFSH26800 Installation of Kitchen Cabinet 12.00 02-Sep-15 15-Sep-15 03-Nov-15 16-Nov-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 127.00 22-Oct-14 20-May-15 09-Nov-14 07-Apr-15 63.00 0% 0% 0.00
DHFSH26240 Corridor/Lift Lobby Floor Screed 4.00 22-Oct-14 27-Oct-14 09-Nov-14 12-Nov-14 53.00 0% 0% 0.00
DHFSH26270 Lift Lobby Painting - Primer & Stucco 6.00 28-Oct-14 03-Nov-14 13-Nov-14 19-Nov-14 53.00 0% 0% 0.00
DHFSH26310 Lift Lobby False Ceiling Suspension 6.00 11-Dec-14 18-Dec-14 08-Feb-15 15-Feb-15 -13.00 0% 0% 0.00
DHFSH26360 Lift Lobby False Ceiling Tiling / Boarding 5.00 05-Jan-15 10-Jan-15 19-Feb-15 25-Feb-15 79.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - Level 26
Construction of Horizontals - L26
Construction of Verticals - L26
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 35 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH26410 Lift Lobby Painting - 1st Coat 6.00 11-Jan-15 17-Jan-15 25-Feb-15 04-Mar-15 79.00 0% 0% 0.00
DHFSH26440 Installation of Steel Doors & Windows 3.00 18-May-15 20-May-15 28-Mar-15 30-Mar-15 43.00 0% 0% 0.00
DHFSH26470 Lift Lobby Flooring 6.00 05-Mar-15 11-Mar-15 25-Mar-15 31-Mar-15 63.00 0% 0% 0.00
DHFSH26490 Utility Rooms- Epoxy Flooring 6.00 12-Mar-15 18-Mar-15 01-Apr-15 07-Apr-15 63.00 0% 0% 0.00
Staircase 134.00 14-Oct-14 28-May-15 01-Nov-14 07-Apr-15 74.00 0% 0% 0.00
DHFSH26200 Staircase Plastering 4.00 14-Oct-14 18-Oct-14 01-Nov-14 04-Nov-14 158.00 0% 0% 0.00
DHFSH26280 Staircase Painting - Primer & Stucco 6.00 04-Nov-14 10-Nov-14 20-Nov-14 26-Nov-14 145.00 0% 0% 0.00
DHFSH26320 Staircase Handrail Fixing 3.00 14-Feb-15 17-Feb-15 27-Dec-14 29-Dec-14 140.00 0% 0% 0.00
DHFSH26330 Staircase Painting 1st Coat 3.00 17-Feb-15 21-Feb-15 03-Mar-15 07-Mar-15 87.00 0% 0% 0.00
DHFSH26340 Staircase Final Painting 5.00 21-May-15 26-May-15 31-Mar-15 05-Apr-15 74.00 0% 0% 0.00
DHFSH26380 Staircase Epoxy Flooring 2.00 27-May-15 28-May-15 06-Apr-15 07-Apr-15 74.00 0% 0% 0.00
General 371.00 24-Aug-14 20-Oct-15 19-Aug-14 A 14-Dec-15 -43.00 0% 0% 0.00
DHSTR26000 Access from Structure 0.00 24-Aug-14 19-Aug-14 A 100% 100% 0.00
DHFSH26510 Snagging & De-Snagging 12.00 06-Oct-15 20-Oct-15 30-Nov-15 14-Dec-15 -43.00 0% 0% 0.00
MEP - LEVEL 26 535.00 23-Jul-14 26-Aug-15 17-Jul-14 A 08-Dec-15 -82.00 63.79% 35% 0.55
DHMEP26000 Embeded Conduits & Boxex - Concrete Works 3.00 23-Jul-14 26-Jul-14 17-Jul-14 A 23-Jul-14 A 100% 100% 0.00
DHMEP26100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C24a-bAliungg- 1, 4Wiring et1c3-Sep-14 19-Aug-14 A 21-Sep-14 A 100% 100% 1.00
DHMEP26130 Cable Trays & Cable Trunking 6.00 21-Sep-14 27-Sep-14 19-Aug-14 A 21-Sep-14 A 100% 100% 0.00
DHMEP26120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 25-Sep-14 01-Oct-14 14-Oct-14 20-Oct-14 53.00 83.33% 0% 0.00
DHMEP26160 Pressure Testing of Pipes 8.00 02-Oct-14 18-Oct-14 16-Sep-14 A 30-Oct-14 77.00 0% 33% 0.00
DHMEP26110 MEP Works in Risers& Clearance 6.00 16-Nov-14 22-Nov-14 08-Sep-14 A 05-Jan-15 -33.00 0% 12% 0.00
DHMEP26140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es28-Dec-14 04-Jan-15 20-Sep-14 A 19-Feb-15 -12.00 0% 1% 0.00
DHMEP26150 MEP Final Fixes 6.00 13-Jul-15 21-Jul-15 12-Sep-15 17-Sep-15 -44.00 0% 0% 0.00
DHMEP06380 Sanitary ware /Toilet accessories 6.00 16-Jul-15 25-Jul-15 15-Sep-15 21-Sep-15 -26.00 0% 0% 0.00
DHMEP26200 Pre-Testing & Commissioning 7.00 19-Aug-15 26-Aug-15 17-Oct-15 24-Oct-15 -44.00 0% 0% 0.00
DHMEP26010 Busbar - L26 to L30 20.00 21-May-15 13-Jun-15 15-Nov-15 08-Dec-15 -144.00 0% 0% 0.00
LEVEL 27 543.00 14-Jul-14 27-Oct-15 04-Jul-14 A 21-Dec-15 -43.00 52.87% 52.22% 0.99
STRUCTURAL WORKS - LEVEL 27 61.00 14-Jul-14 05-Aug-14 04-Jul-14 A 05-Aug-14 A 100% 100% 1.00
DHCWA28100 Core Wall - L27 6.00 14-Jul-14 20-Jul-14 04-Jul-14 A 14-Jul-14 A 100% 100% 1.00
DHCWA28120 Tower Crane Jump 1.00 20-Jul-14 20-Jul-14 15-Jul-14 A 17-Jul-14 A 100% 100% 0.00
DHSLA27100 Construction of Horizontals - L27 3.00 31-Jul-14 03-Aug-14 27-Jul-14 A 31-Jul-14 A 100% 100% 1.00
DHCWA28110 Construction of Verticals - L27 2.00 04-Aug-14 05-Aug-14 04-Aug-14 A 05-Aug-14 A 100% 100% 1.00
STAIRCASES 4.00 11-Oct-14 14-Oct-14 09-Sep-14 A 14-Sep-14 A 0% 0% 0.00
A1720 Stair # 1 4.00 11-Oct-14 14-Oct-14 09-Sep-14 A 14-Sep-14 A 0% 100% 0.00
A1730 Stair # 2 3.00 11-Oct-14 13-Oct-14 09-Sep-14 A 14-Sep-14 A 0% 100% 0.00
FINISHES WORKS - LEVEL 27 377.00 01-Sep-14 27-Oct-15 04-Sep-14 A 21-Dec-15 -43.00 10.4% 6.94% 0.67
Dry area 346.00 22-Sep-14 01-Oct-15 25-Sep-14 A 30-Nov-15 -38.00 24.4% 16.67% 0.68
DHFSH27100 Block Work in Dry Area 6.00 22-Sep-14 28-Sep-14 25-Sep-14 A 12-Oct-14 3.00 100% 70% 0.70
DHFSH27120 Marking,Cutting & Chasing - Dry Area 4.00 29-Sep-14 02-Oct-14 13-Oct-14 16-Oct-14 53.00 50% 0% 0.00
DHFSH27130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 06-Oct-14 09-Oct-14 18-Oct-14 21-Oct-14 55.00 0% 0% 0.00
DHFSH27160 Plaster in Dry Area 8.00 13-Oct-14 21-Oct-14 26-Oct-14 03-Nov-14 53.00 0% 0% 0.00
DHMEP27190 Dry Area Floor Screed 7.00 22-Oct-14 30-Oct-14 04-Nov-14 11-Nov-14 53.00 0% 0% 0.00
DHFSH27230 Dry Area Painting - Primer 4.00 01-Nov-14 04-Nov-14 12-Nov-14 16-Nov-14 109.00 0% 0% 0.00
DHFSH27260 Dry Area Painting - Stucco 6.00 05-Nov-14 11-Nov-14 17-Nov-14 23-Nov-14 109.00 0% 0% 0.00
DHFSH27290 Dry Area False Ceiling Suspension 6.00 03-Dec-14 10-Dec-14 31-Jan-15 07-Feb-15 -23.00 0% 0% 0.00
DHFSH27350 Dry Area False Ceiling Tiling / Boarding 5.00 08-Jan-15 13-Jan-15 23-Feb-15 01-Mar-15 28.00 0% 0% 0.00
DHFSH27400 Dry Area Painting - 1st Coat 5.00 14-Jan-15 19-Jan-15 01-Mar-15 07-Mar-15 28.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Busbar - L26 to L30
Core Wall - L27
Tower Crane Jump
Construction of Horizontals - L27
Construction of Verticals - L27
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 36 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH27450 Dry Area Flooring 5.00 05-Mar-15 10-Mar-15 25-Mar-15 30-Mar-15 16.00 0% 0% 0.00
DHFSH27430 Installation of Timber Doors & Ironmongery 4.00 09-Jul-15 13-Jul-15 08-Sep-15 12-Sep-15 -50.00 0% 0% 0.00
DHFSH27802 Installation of Wardrobe 12.00 26-Aug-15 08-Sep-15 27-Oct-15 09-Nov-15 -50.00 0% 0% 0.00
DHFSH27500 Paint Final Coat 6.00 26-Sep-15 01-Oct-15 24-Nov-15 30-Nov-15 -38.00 0% 0% 0.00
Wet area 340.00 22-Sep-14 22-Sep-15 25-Sep-14 A 23-Nov-15 -50.00 0.52% 0% 0.00
DHFSH27110 Block Work in Wet Area 6.00 22-Sep-14 28-Sep-14 25-Sep-14 A 12-Oct-14 53.00 100% 70% 0.00
DHFSH27140 Marking,Cutting & Chasing - Wet Area 4.00 29-Sep-14 02-Oct-14 13-Oct-14 16-Oct-14 53.00 50% 0% 0.00
DHFSH27150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 06-Oct-14 09-Oct-14 18-Oct-14 21-Oct-14 61.00 0% 0% 0.00
DHMEP27170 Plaster in Wet Area 4.00 13-Oct-14 16-Oct-14 26-Oct-14 29-Oct-14 59.00 0% 0% 0.00
DHMEP27180 Wet Area Wall Tiling 6.00 03-Dec-14 10-Dec-14 08-Jan-15 14-Jan-15 1.00 0% 0% 0.00
DHFSH27300 Wet Area False Ceiling Suspension 5.00 10-Dec-14 16-Dec-14 07-Feb-15 12-Feb-15 -14.00 0% 0% 0.00
DHFSH27370 Wet Area False Ceiling Tiling/Boarding 4.00 08-Jan-15 12-Jan-15 23-Feb-15 28-Feb-15 10.00 0% 0% 0.00
DHFSH27210 Wet Area Waterproofing 4.00 13-Jan-15 17-Jan-15 28-Feb-15 04-Mar-15 10.00 0% 0% 0.00
DHFSH27220 Wet Area Floor Screed 4.00 18-Jan-15 21-Jan-15 04-Mar-15 09-Mar-15 10.00 0% 0% 0.00
DHFSH27250 Wet Area Floor Tiling 5.00 22-Jan-15 27-Jan-15 09-Mar-15 15-Mar-15 10.00 0% 0% 0.00
DHFSH06710 Cabinet Carcass 5.00 08-Mar-15 12-Mar-15 28-Mar-15 01-Apr-15 -1.00 0% 0% 0.00
DHFSH27420 Installation of Shower Enclosure 4.00 13-Jul-15 16-Jul-15 12-Sep-15 15-Sep-15 -45.00 0% 0% 0.00
DHFSH27390 Installation of Vanity Counters & Tops 5.00 15-Jul-15 22-Jul-15 14-Sep-15 19-Sep-15 -50.00 0% 0% 0.00
DHFSH27800 Installation of Kitchen Cabinet 12.00 09-Sep-15 22-Sep-15 10-Nov-15 23-Nov-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 129.00 01-Nov-14 24-May-15 12-Nov-14 13-Apr-15 60.00 0% 0% 0.00
DHFSH27240 Corridor/Lift Lobby Floor Screed 4.00 01-Nov-14 04-Nov-14 12-Nov-14 16-Nov-14 53.00 0% 0% 0.00
DHFSH27270 Lift Lobby Painting - Primer & Stucco 6.00 05-Nov-14 11-Nov-14 17-Nov-14 23-Nov-14 53.00 0% 0% 0.00
DHFSH27310 Lift Lobby False Ceiling Suspension 6.00 16-Dec-14 23-Dec-14 12-Feb-15 19-Feb-15 -14.00 0% 0% 0.00
DHFSH27360 Lift Lobby False Ceiling Tiling / Boarding 5.00 08-Jan-15 13-Jan-15 23-Feb-15 01-Mar-15 79.00 0% 0% 0.00
DHFSH27410 Lift Lobby Painting - 1st Coat 6.00 14-Jan-15 20-Jan-15 01-Mar-15 08-Mar-15 79.00 0% 0% 0.00
DHFSH27440 Installation of Steel Doors & Windows 3.00 21-May-15 24-May-15 02-Apr-15 05-Apr-15 41.00 0% 0% 0.00
DHFSH27470 Lift Lobby Flooring 6.00 11-Mar-15 17-Mar-15 31-Mar-15 06-Apr-15 60.00 0% 0% 0.00
DHFSH27490 Utility Rooms- Epoxy Flooring 6.00 18-Mar-15 24-Mar-15 07-Apr-15 13-Apr-15 60.00 0% 0% 0.00
Staircase 136.00 22-Oct-14 01-Jun-15 04-Nov-14 13-Apr-15 73.00 0% 0% 0.00
DHFSH27200 Staircase Plastering 4.00 22-Oct-14 27-Oct-14 04-Nov-14 08-Nov-14 158.00 0% 0% 0.00
DHFSH27280 Staircase Painting - Primer & Stucco 6.00 12-Nov-14 18-Nov-14 24-Nov-14 30-Nov-14 145.00 0% 0% 0.00
DHFSH27320 Staircase Handrail Fixing 3.00 17-Feb-15 21-Feb-15 30-Dec-14 03-Jan-15 140.00 0% 0% 0.00
DHFSH27330 Staircase Painting 1st Coat 3.00 21-Feb-15 24-Feb-15 07-Mar-15 10-Mar-15 87.00 0% 0% 0.00
DHFSH27340 Staircase Final Painting 5.00 25-May-15 30-May-15 06-Apr-15 11-Apr-15 73.00 0% 0% 0.00
DHFSH27380 Staircase Epoxy Flooring 2.00 31-May-15 01-Jun-15 12-Apr-15 13-Apr-15 73.00 0% 0% 0.00
General 377.00 01-Sep-14 27-Oct-15 04-Sep-14 A 21-Dec-15 -43.00 0% 0% 0.00
DHSTR27000 Access from Structure 0.00 01-Sep-14 04-Sep-14 A 100% 100% 0.00
DHFSH27510 Snagging & De-Snagging 12.00 14-Oct-15 27-Oct-15 08-Dec-15 21-Dec-15 -43.00 0% 0% 0.00
MEP - LEVEL 27 497.00 31-Jul-14 30-Aug-15 27-Jul-14 A 27-Oct-15 -44.00 34.97% 35.32% 1.01
DHMEP27000 Embeded Conduits & Boxex - Concrete Works 3.00 31-Jul-14 03-Aug-14 27-Jul-14 A 31-Jul-14 A 100% 100% 0.00
DHMEP27100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C01a-bSlienpg- 1, 4Wiring et2c1-Sep-14 04-Sep-14 A 23-Sep-14 A 100% 100% 1.00
DHMEP27130 Cable Trays & Cable Trunking 6.00 29-Sep-14 07-Oct-14 04-Sep-14 A 19-Oct-14 62.00 33.33% 0% 0.00
DHMEP27120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 06-Oct-14 12-Oct-14 18-Oct-14 23-Oct-14 53.00 0% 0% 0.00
DHMEP27160 Pressure Testing of Pipes 12.00 13-Oct-14 27-Oct-14 26-Sep-14 A 03-Nov-14 77.00 0% 33% 0.00
DHMEP27110 MEP Works in Risers& Clearance 6.00 23-Nov-14 29-Nov-14 15-Sep-14 A 11-Jan-15 -33.00 0% 12% 0.00
DHMEP27140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es31-Dec-14 07-Jan-15 22-Sep-14 A 23-Feb-15 -12.00 0% 12% 0.00
DHMEP27150 MEP Final Fixes 6.00 20-Jul-15 26-Jul-15 16-Sep-15 22-Sep-15 -45.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 37 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHMEP06390 Sanitary ware /Toilet accessories 6.00 23-Jul-15 29-Jul-15 20-Sep-15 28-Sep-15 -27.00 0% 0% 0.00
DHMEP27200 Pre-Testing & Commissioning 7.00 23-Aug-15 30-Aug-15 20-Oct-15 27-Oct-15 -44.00 0% 0% 0.00
LEVEL 28 546.00 21-Jul-14 03-Nov-15 15-Jul-14 A 28-Dec-15 -43.00 51.27% 51% 0.99
STRUCTURAL WORKS - LEVEL 28 18.00 21-Jul-14 12-Aug-14 15-Jul-14 A 11-Aug-14 A 100% 100% 1.00
DHCWA29100 Core Wall - L28 6.00 21-Jul-14 27-Jul-14 15-Jul-14 A 21-Jul-14 A 100% 100% 1.00
DHSLA28100 Construction of Horizontals - L28 3.00 06-Aug-14 09-Aug-14 06-Aug-14 A 09-Aug-14 A 100% 100% 1.00
DHCWA29110 Construction of Verticals - L28 3.00 10-Aug-14 12-Aug-14 10-Aug-14 A 11-Aug-14 A 100% 100% 1.00
STAIRCASES 4.00 15-Oct-14 19-Oct-14 18-Oct-14 21-Oct-14 50.00 0% 0% 0.00
A1740 Stair # 1 4.00 15-Oct-14 19-Oct-14 18-Oct-14 21-Oct-14 13.00 0% 0% 0.00
A1750 Stair # 2 3.00 15-Oct-14 18-Oct-14 19-Oct-14 21-Oct-14 50.00 0% 0% 0.00
FINISHES WORKS - LEVEL 28 383.00 07-Sep-14 03-Nov-15 08-Sep-14 A 28-Dec-15 -43.00 3.31% 1.49% 0.45
Dry area 347.00 29-Sep-14 08-Oct-15 25-Sep-14 A 08-Dec-15 -38.00 7.94% 3.57% 0.45
DHFSH28100 Block Work in Dry Area 6.00 29-Sep-14 07-Oct-14 25-Sep-14 A 18-Oct-14 3.00 33.33% 15% 0.45
DHFSH28120 Marking,Cutting & Chasing - Dry Area 4.00 08-Oct-14 12-Oct-14 19-Oct-14 22-Oct-14 51.00 0% 0% 0.00
DHFSH28130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 13-Oct-14 16-Oct-14 23-Oct-14 28-Oct-14 53.00 0% 0% 0.00
DHFSH28160 Plaster in Dry Area 8.00 20-Oct-14 29-Oct-14 01-Nov-14 09-Nov-14 51.00 0% 0% 0.00
DHMEP28190 Dry Area Floor Screed 7.00 30-Oct-14 06-Nov-14 10-Nov-14 17-Nov-14 51.00 0% 0% 0.00
DHFSH28230 Dry Area Painting - Primer 4.00 08-Nov-14 11-Nov-14 18-Nov-14 22-Nov-14 107.00 0% 0% 0.00
DHFSH28260 Dry Area Painting - Stucco 6.00 12-Nov-14 18-Nov-14 23-Nov-14 29-Nov-14 107.00 0% 0% 0.00
DHFSH28290 Dry Area False Ceiling Suspension 6.00 08-Dec-14 15-Dec-14 04-Feb-15 11-Feb-15 -23.00 0% 0% 0.00
DHFSH28350 Dry Area False Ceiling Tiling / Boarding 5.00 12-Jan-15 17-Jan-15 28-Feb-15 05-Mar-15 27.00 0% 0% 0.00
DHFSH28400 Dry Area Painting - 1st Coat 5.00 18-Jan-15 22-Jan-15 05-Mar-15 11-Mar-15 27.00 0% 0% 0.00
DHFSH28450 Dry Area Flooring 5.00 11-Mar-15 16-Mar-15 31-Mar-15 05-Apr-15 16.00 0% 0% 0.00
DHFSH28430 Installation of Timber Doors & Ironmongery 4.00 14-Jul-15 20-Jul-15 13-Sep-15 16-Sep-15 -50.00 0% 0% 0.00
DHFSH28802 Installation of Wardrobe 12.00 02-Sep-15 15-Sep-15 03-Nov-15 16-Nov-15 -50.00 0% 0% 0.00
DHFSH28500 Paint Final Coat 6.00 03-Oct-15 08-Oct-15 01-Dec-15 08-Dec-15 -38.00 0% 0% 0.00
Wet area 341.00 29-Sep-14 01-Oct-15 25-Sep-14 A 30-Nov-15 -50.00 0% 0% 0.00
DHFSH28110 Block Work in Wet Area 6.00 29-Sep-14 07-Oct-14 25-Sep-14 A 18-Oct-14 51.00 33.33% 15% 0.00
DHFSH28140 Marking,Cutting & Chasing - Wet Area 4.00 08-Oct-14 12-Oct-14 19-Oct-14 22-Oct-14 51.00 0% 0% 0.00
DHFSH28150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 13-Oct-14 16-Oct-14 23-Oct-14 28-Oct-14 60.00 0% 0% 0.00
DHMEP28170 Plaster in Wet Area 4.00 20-Oct-14 23-Oct-14 01-Nov-14 04-Nov-14 58.00 0% 0% 0.00
DHMEP28180 Wet Area Wall Tiling 6.00 08-Dec-14 15-Dec-14 13-Jan-15 19-Jan-15 1.00 0% 0% 0.00
DHFSH28300 Wet Area False Ceiling Suspension 5.00 15-Dec-14 21-Dec-14 11-Feb-15 17-Feb-15 -15.00 0% 0% 0.00
DHFSH28370 Wet Area False Ceiling Tiling/Boarding 4.00 12-Jan-15 15-Jan-15 28-Feb-15 04-Mar-15 11.00 0% 0% 0.00
DHFSH28210 Wet Area Waterproofing 4.00 17-Jan-15 20-Jan-15 04-Mar-15 09-Mar-15 11.00 0% 0% 0.00
DHFSH28220 Wet Area Floor Screed 4.00 21-Jan-15 25-Jan-15 09-Mar-15 14-Mar-15 11.00 0% 0% 0.00
DHFSH28250 Wet Area Floor Tiling 5.00 26-Jan-15 31-Jan-15 14-Mar-15 19-Mar-15 11.00 0% 0% 0.00
DHFSH06720 Cabinet Carcass 4.00 14-Mar-15 17-Mar-15 02-Apr-15 06-Apr-15 -1.00 0% 0% 0.00
DHFSH28420 Installation of Shower Enclosure 4.00 20-Jul-15 23-Jul-15 16-Sep-15 20-Sep-15 -46.00 0% 0% 0.00
DHFSH28390 Installation of Vanity Counters & Tops 5.00 22-Jul-15 27-Jul-15 19-Sep-15 26-Sep-15 -50.00 0% 0% 0.00
DHFSH28800 Installation of Kitchen Cabinet 12.00 16-Sep-15 01-Oct-15 17-Nov-15 30-Nov-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 129.00 08-Nov-14 27-May-15 18-Nov-14 19-Apr-15 57.00 0% 0% 0.00
DHFSH28240 Corridor/Lift Lobby Floor Screed 4.00 08-Nov-14 11-Nov-14 18-Nov-14 22-Nov-14 51.00 0% 0% 0.00
DHFSH28270 Lift Lobby Painting - Primer & Stucco 6.00 12-Nov-14 18-Nov-14 23-Nov-14 29-Nov-14 51.00 0% 0% 0.00
DHFSH28310 Lift Lobby False Ceiling Suspension 6.00 21-Dec-14 28-Dec-14 17-Feb-15 24-Feb-15 -15.00 0% 0% 0.00
DHFSH28360 Lift Lobby False Ceiling Tiling / Boarding 5.00 12-Jan-15 17-Jan-15 28-Feb-15 05-Mar-15 78.00 0% 0% 0.00
DHFSH28410 Lift Lobby Painting - 1st Coat 6.00 18-Jan-15 24-Jan-15 05-Mar-15 12-Mar-15 78.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - L28
Construction of Horizontals - L28
Construction of Verticals - L28
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 38 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH28440 Installation of Steel Doors & Windows 3.00 25-May-15 27-May-15 07-Apr-15 09-Apr-15 40.00 0% 0% 0.00
DHFSH28470 Lift Lobby Flooring 6.00 17-Mar-15 23-Mar-15 06-Apr-15 12-Apr-15 57.00 0% 0% 0.00
DHFSH28490 Utility Rooms- Epoxy Flooring 6.00 24-Mar-15 30-Mar-15 13-Apr-15 19-Apr-15 57.00 0% 0% 0.00
Staircase 135.00 30-Oct-14 04-Jun-15 10-Nov-14 18-Apr-15 71.00 0% 0% 0.00
DHFSH28200 Staircase Plastering 4.00 30-Oct-14 03-Nov-14 10-Nov-14 13-Nov-14 156.00 0% 0% 0.00
DHFSH28280 Staircase Painting - Primer & Stucco 6.00 19-Nov-14 25-Nov-14 30-Nov-14 07-Dec-14 143.00 0% 0% 0.00
DHFSH28320 Staircase Handrail Fixing 3.00 21-Feb-15 24-Feb-15 04-Jan-15 06-Jan-15 140.00 0% 0% 0.00
DHFSH28330 Staircase Painting 1st Coat 3.00 24-Feb-15 28-Feb-15 10-Mar-15 14-Mar-15 87.00 0% 0% 0.00
DHFSH28340 Staircase Final Painting 5.00 28-May-15 02-Jun-15 11-Apr-15 15-Apr-15 71.00 0% 0% 0.00
DHFSH28380 Staircase Epoxy Flooring 2.00 03-Jun-15 04-Jun-15 16-Apr-15 18-Apr-15 71.00 0% 0% 0.00
General 383.00 07-Sep-14 03-Nov-15 08-Sep-14 A 28-Dec-15 -43.00 0% 0% 0.00
DHSTR28000 Access from Structure 0.00 07-Sep-14 08-Sep-14 A 100% 100% 0.00
DHFSH28510 Snagging & De-Snagging 12.00 21-Oct-15 03-Nov-15 15-Dec-15 28-Dec-15 -43.00 0% 0% 0.00
MEP - LEVEL 28 497.00 06-Aug-14 02-Sep-15 06-Aug-14 A 31-Oct-15 -44.00 34.97% 35.32% 1.01
DHMEP28000 Embeded Conduits & Boxex - Concrete Works 3.00 06-Aug-14 09-Aug-14 06-Aug-14 A 09-Aug-14 A 100% 100% 0.00
DHMEP28100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C08a-bSlienpg- 1, 4Wiring et2c8-Sep-14 08-Sep-14 A 29-Sep-14 A 100% 100% 1.00
DHMEP28130 Cable Trays & Cable Trunking 6.00 08-Oct-14 14-Oct-14 08-Sep-14 A 26-Oct-14 61.00 0% 0% 0.00
DHMEP28120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 13-Oct-14 19-Oct-14 23-Oct-14 30-Oct-14 51.00 0% 0% 0.00
DHMEP28160 Pressure Testing of Pipes 12.00 20-Oct-14 03-Nov-14 29-Sep-14 A 09-Nov-14 75.00 0% 33% 0.00
DHMEP28110 MEP Works in Risers& Clearance 6.00 30-Nov-14 07-Dec-14 21-Sep-14 A 17-Jan-15 -33.00 0% 12% 0.00
DHMEP28140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es05-Jan-15 11-Jan-15 24-Sep-14 A 28-Feb-15 -13.00 0% 12% 0.00
DHMEP28150 MEP Final Fixes 6.00 25-Jul-15 30-Jul-15 21-Sep-15 29-Sep-15 -46.00 0% 0% 0.00
DHMEP06400 Sanitary ware /Toilet accessories 6.00 28-Jul-15 03-Aug-15 27-Sep-15 03-Oct-15 -28.00 0% 0% 0.00
DHMEP28200 Pre-Testing & Commissioning 7.00 26-Aug-15 02-Sep-15 24-Oct-15 31-Oct-15 -44.00 0% 0% 0.00
LEVEL 29 565.00 30-Jul-14 14-Nov-15 22-Jul-14 A 12-Jan-16 -50.00 48.72% 47.32% 0.97
STRUCTURAL WORKS - LEVEL 29 18.00 30-Jul-14 19-Aug-14 22-Jul-14 A 16-Aug-14 A 100% 100% 1.00
DHCWA30100 Core Wall - L29 5.00 30-Jul-14 04-Aug-14 22-Jul-14 A 27-Jul-14 A 100% 100% 1.00
DHSLA29100 Construction of Horizontals - L29 3.00 13-Aug-14 16-Aug-14 12-Aug-14 A 14-Aug-14 A 100% 100% 1.00
DHCWA30110 Construction of Verticals - L29 3.00 17-Aug-14 19-Aug-14 15-Aug-14 A 16-Aug-14 A 100% 100% 1.00
STAIRCASES 4.00 19-Oct-14 23-Oct-14 22-Oct-14 27-Oct-14 50.00 0% 0% 0.00
A1760 Stair # 1 4.00 20-Oct-14 23-Oct-14 22-Oct-14 27-Oct-14 13.00 0% 0% 0.00
A1770 Stair # 2 4.00 19-Oct-14 22-Oct-14 22-Oct-14 27-Oct-14 50.00 0% 0% 0.00
FINISHES WORKS - LEVEL 29 396.00 13-Sep-14 14-Nov-15 14-Sep-14 A 12-Jan-16 -50.00 0% 0.55% 0.00
Dry area 378.00 13-Sep-14 31-Oct-15 25-Sep-14 A 29-Dec-15 -50.00 0% 1.19% 0.00
DHFSH29102 Block Work for Mechanical Portion 8.00 13-Sep-14 21-Sep-14 25-Sep-14 A 12-Oct-14 36.00 100% 5% 0.00
DHFSH29100 Block Work in Dry Area 6.00 08-Oct-14 14-Oct-14 25-Sep-14 A 22-Oct-14 3.00 0% 5% 0.00
DHFSH29120 Marking,Cutting & Chasing - Dry Area 4.00 15-Oct-14 19-Oct-14 23-Oct-14 28-Oct-14 50.00 0% 0% 0.00
DHFSH29130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 20-Oct-14 23-Oct-14 29-Oct-14 02-Nov-14 52.00 0% 0% 0.00
DHFSH29600 Service Area Civil Works 20.00 22-Sep-14 16-Oct-14 13-Oct-14 05-Nov-14 36.00 40% 0% 0.00
DHFSH29160 Plaster in Dry Area 8.00 28-Oct-14 05-Nov-14 05-Nov-14 13-Nov-14 50.00 0% 0% 0.00
DHMEP29190 Dry Area Floor Screed 7.00 06-Nov-14 13-Nov-14 15-Nov-14 22-Nov-14 50.00 0% 0% 0.00
DHFSH29230 Dry Area Painting - Primer 4.00 15-Nov-14 18-Nov-14 23-Nov-14 26-Nov-14 106.00 0% 0% 0.00
DHFSH29260 Dry Area Painting - Stucco 6.00 19-Nov-14 25-Nov-14 27-Nov-14 04-Dec-14 106.00 0% 0% 0.00
DHFSH29290 Dry Area False Ceiling Suspension 6.00 13-Dec-14 20-Dec-14 09-Feb-15 16-Feb-15 -23.00 0% 0% 0.00
DHFSH29350 Dry Area False Ceiling Tiling / Boarding 5.00 19-Jan-15 24-Jan-15 07-Mar-15 12-Mar-15 24.00 0% 0% 0.00
DHFSH29400 Dry Area Painting - 1st Coat 5.00 25-Jan-15 29-Jan-15 12-Mar-15 18-Mar-15 24.00 0% 0% 0.00
DHFSH29450 Dry Area Flooring 5.00 16-Mar-15 21-Mar-15 05-Apr-15 09-Apr-15 16.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - L29
Construction of Horizontals - L29
Construction of Verticals - L29
Stair # 1
Stair # 2
Block Work for Mechanical Portion
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Service Area Civil Works
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 39 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH29430 Installation of Timber Doors & Ironmongery 5.00 21-Jul-15 26-Jul-15 17-Sep-15 22-Sep-15 -50.00 0% 0% 0.00
DHFSH29802 Installation of Wardrobe 12.00 09-Sep-15 22-Sep-15 10-Nov-15 23-Nov-15 -50.00 0% 0% 0.00
DHFSH29500 Paint Final Coat 6.00 25-Oct-15 31-Oct-15 23-Dec-15 29-Dec-15 -50.00 0% 0% 0.00
Wet area 343.00 08-Oct-14 08-Oct-15 25-Sep-14 A 08-Dec-15 -50.00 0% 0% 0.00
DHFSH29110 Block Work in Wet Area 6.00 08-Oct-14 14-Oct-14 25-Sep-14 A 22-Oct-14 50.00 0% 5% 0.00
DHFSH29140 Marking,Cutting & Chasing - Wet Area 4.00 15-Oct-14 19-Oct-14 23-Oct-14 28-Oct-14 50.00 0% 0% 0.00
DHFSH29150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 20-Oct-14 23-Oct-14 29-Oct-14 02-Nov-14 60.00 0% 0% 0.00
DHMEP29170 Plaster in Wet Area 4.00 28-Oct-14 01-Nov-14 05-Nov-14 09-Nov-14 58.00 0% 0% 0.00
DHMEP29180 Wet Area Wall Tiling 6.00 13-Dec-14 20-Dec-14 18-Jan-15 24-Jan-15 1.00 0% 0% 0.00
DHFSH29300 Wet Area False Ceiling Suspension 5.00 20-Dec-14 25-Dec-14 16-Feb-15 22-Feb-15 -16.00 0% 0% 0.00
DHFSH29370 Wet Area False Ceiling Tiling/Boarding 4.00 19-Jan-15 22-Jan-15 07-Mar-15 11-Mar-15 24.00 0% 0% 0.00
DHFSH29210 Wet Area Waterproofing 4.00 24-Jan-15 27-Jan-15 11-Mar-15 16-Mar-15 24.00 0% 0% 0.00
DHFSH29220 Wet Area Floor Screed 4.00 28-Jan-15 01-Feb-15 16-Mar-15 21-Mar-15 24.00 0% 0% 0.00
DHFSH29250 Wet Area Floor Tiling 5.00 02-Feb-15 07-Feb-15 21-Mar-15 26-Mar-15 24.00 0% 0% 0.00
DHFSH29420 Installation of Shower Enclosure 4.00 26-Jul-15 29-Jul-15 22-Sep-15 28-Sep-15 -48.00 0% 0% 0.00
DHFSH29390 Installation of Vanity Counters & Tops 5.00 27-Jul-15 01-Aug-15 26-Sep-15 30-Sep-15 -50.00 0% 0% 0.00
DHFSH29800 Installation of Kitchen Cabinets 12.00 26-Sep-15 08-Oct-15 24-Nov-15 08-Dec-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 129.00 15-Nov-14 31-May-15 23-Nov-14 23-Apr-15 132.00 0% 0% 0.00
DHFSH29240 Corridor/Lift Lobby Floor Screed 4.00 15-Nov-14 18-Nov-14 23-Nov-14 26-Nov-14 50.00 0% 0% 0.00
DHFSH29270 Lift Lobby Painting - Primer & Stucco 6.00 19-Nov-14 25-Nov-14 27-Nov-14 04-Dec-14 50.00 0% 0% 0.00
DHFSH29310 Lift Lobby False Ceiling Suspension 6.00 25-Dec-14 03-Jan-15 22-Feb-15 01-Mar-15 -16.00 0% 0% 0.00
DHFSH29360 Lift Lobby False Ceiling Tiling / Boarding 5.00 19-Jan-15 24-Jan-15 07-Mar-15 12-Mar-15 79.00 0% 0% 0.00
DHFSH29410 Lift Lobby Painting - 1st Coat 6.00 25-Jan-15 31-Jan-15 12-Mar-15 19-Mar-15 79.00 0% 0% 0.00
DHFSH29440 Installation of Steel Doors & Windows 3.00 28-May-15 31-May-15 11-Apr-15 13-Apr-15 40.00 0% 0% 0.00
DHFSH29470 Lift Lobby Flooring 6.00 22-Mar-15 28-Mar-15 11-Apr-15 16-Apr-15 128.00 0% 0% 0.00
DHFSH29490 Utility Rooms- Epoxy Flooring 6.00 29-Mar-15 04-Apr-15 18-Apr-15 23-Apr-15 132.00 0% 0% 0.00
Staircase 134.00 06-Nov-14 08-Jun-15 15-Nov-14 21-Apr-15 70.00 0% 0% 0.00
DHFSH29200 Staircase Plastering 4.00 06-Nov-14 10-Nov-14 15-Nov-14 18-Nov-14 155.00 0% 0% 0.00
DHFSH29280 Staircase Painting - Primer & Stucco 6.00 26-Nov-14 03-Dec-14 06-Dec-14 11-Dec-14 142.00 0% 0% 0.00
DHFSH29320 Staircase Handrail Fixing 3.00 24-Feb-15 28-Feb-15 07-Jan-15 10-Jan-15 140.00 0% 0% 0.00
DHFSH29330 Staircase Painting 1st Coat 3.00 28-Feb-15 03-Mar-15 18-Mar-15 22-Mar-15 83.00 0% 0% 0.00
DHFSH29340 Staircase Final Painting 5.00 01-Jun-15 06-Jun-15 14-Apr-15 19-Apr-15 67.00 0% 0% 0.00
DHFSH29380 Staircase Epoxy Flooring 2.00 07-Jun-15 08-Jun-15 20-Apr-15 21-Apr-15 70.00 0% 0% 0.00
General 396.00 13-Sep-14 14-Nov-15 14-Sep-14 A 12-Jan-16 -50.00 0% 0% 0.00
DHSTR29000 Access from Structure 0.00 13-Sep-14 14-Sep-14 A 100% 100% 0.00
DHFSH29510 Snagging & De-Snagging 12.00 01-Nov-15 14-Nov-15 30-Dec-15 12-Jan-16 -50.00 0% 0% 0.00
MEP - LEVEL 29 515.00 11-Aug-14 13-Sep-15 12-Aug-14 A 14-Nov-15 -50.00 25.83% 22.23% 0.86
DHMEP29000 Embeded Conduits & Boxex - Concrete Works 6.00 11-Aug-14 17-Aug-14 12-Aug-14 A 14-Aug-14 A 100% 100% 0.00
DHMEP29100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C15a-bSlienpg- 1, 4Wiring et0c7-Oct-14 14-Sep-14 A 11-Oct-14 -5.00 77.78% 66% 0.85
DHMEP29130 Cable Trays & Cable Trunking 6.00 15-Oct-14 21-Oct-14 14-Sep-14 A 30-Oct-14 61.00 0% 0% 0.00
DHMEP29120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 20-Oct-14 27-Oct-14 29-Oct-14 04-Nov-14 50.00 0% 0% 0.00
DHMEP29610 Piping Works 21.00 18-Oct-14 11-Nov-14 06-Nov-14 30-Nov-14 36.00 0% 0% 0.00
DHMEP29160 Pressure Testing of Pipes 12.00 26-Nov-14 10-Dec-14 16-Dec-14 29-Dec-14 39.00 0% 0% 0.00
DHMEP29600 Flushing the Loop upto L 30 45.00 18-Oct-14 10-Dec-14 06-Nov-14 29-Dec-14 37.00 0% 0% 0.00
DHMEP29620 Ducting ,Cabling,Wiring& Connections 30.00 12-Nov-14 17-Dec-14 01-Dec-14 06-Jan-15 37.00 0% 0% 0.00
DHMEP29110 MEP Works in Risers& Clearance 6.00 08-Dec-14 14-Dec-14 23-Sep-14 A 22-Jan-15 -33.00 0% 11% 0.00
DHMEP29140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es12-Jan-15 18-Jan-15 29-Sep-14 A 07-Mar-15 -13.00 0% 11% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinets
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Piping Works
Pressure Testing of Pipes
Flushing the Loop upto L 30
Ducting ,Cabling,Wiring& Connections
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 40 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHMEP29150 MEP Final Fixes 6.00 02-Aug-15 08-Aug-15 01-Oct-15 07-Oct-15 -50.00 0% 0% 0.00
DHMEP06410 Sanitary ware /Toilet accessories 6.00 05-Aug-15 11-Aug-15 05-Oct-15 11-Oct-15 -32.00 0% 0% 0.00
DHMEP29200 Pre-Testing & Commissioning 7.00 06-Sep-15 13-Sep-15 07-Nov-15 14-Nov-15 -50.00 0% 0% 0.00
LEVELS 30 (MECHANICAL FLOOR) 565.00 05-Aug-14 21-Nov-15 28-Jul-14 A 19-Jan-16 -50.00 51.15% 41.8% 0.82
LEVEL 30 (MECHANICAL FLOOR) 565.00 05-Aug-14 21-Nov-15 28-Jul-14 A 19-Jan-16 -50.00 51.15% 41.8% 0.82
STRUCTURAL WORKS - LEVEL 30 45.00 05-Aug-14 26-Aug-14 28-Jul-14 A 28-Aug-14 A 100% 100% 1.00
DHCWA31100 Core Wall - L30 6.00 05-Aug-14 11-Aug-14 28-Jul-14 A 13-Aug-14 A 100% 100% 1.00
DHCWA31120 Tower Crane Jump 1.00 05-Aug-14 05-Aug-14 20-Aug-14 A 20-Aug-14 A 100% 100% 0.00
DHSLA30100 Construction of Horizontals - L30 (Mech Floor) 3.00 20-Aug-14 23-Aug-14 17-Aug-14 A 22-Aug-14 A 100% 100% 1.00
DHCWA31110 Construction of Verticals - L30 (Mech Floor) 3.00 24-Aug-14 26-Aug-14 23-Aug-14 A 28-Aug-14 A 100% 100% 1.00
STAIRCASES 4.00 26-Oct-14 29-Oct-14 29-Oct-14 02-Nov-14 49.00 0% 0% 0.00
A1780 Stair # 1 4.00 26-Oct-14 29-Oct-14 29-Oct-14 02-Nov-14 12.00 0% 0% 0.00
A1790 Stair # 2 4.00 26-Oct-14 29-Oct-14 29-Oct-14 02-Nov-14 49.00 0% 0% 0.00
FINISHES WORKS - LEVEL 30 396.00 17-Sep-14 21-Nov-15 01-Oct-14 19-Jan-16 -50.00 0% 0% 0.00
Dry area 353.00 22-Sep-14 10-Oct-15 13-Oct-14 09-Dec-15 -27.00 0% 0% 0.00
DHFSH30600 Service Area Civil Works 20.00 22-Sep-14 16-Oct-14 13-Oct-14 05-Nov-14 43.00 40% 0% 0.00
DHFSH30100 Block Work in Dry Area 6.00 19-Oct-14 26-Oct-14 02-Nov-14 08-Nov-14 -5.00 0% 0% 0.00
DHFSH30120 Marking,Cutting & Chasing - Dry Area 4.00 27-Oct-14 30-Oct-14 09-Nov-14 12-Nov-14 43.00 0% 0% 0.00
DHFSH30130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 01-Nov-14 04-Nov-14 13-Nov-14 17-Nov-14 45.00 0% 0% 0.00
DHFSH30160 Plaster in Dry Area 8.00 08-Nov-14 16-Nov-14 20-Nov-14 29-Nov-14 43.00 0% 0% 0.00
DHMEP30190 Dry Area Floor Screed 7.00 17-Nov-14 24-Nov-14 30-Nov-14 08-Dec-14 43.00 0% 0% 0.00
DHFSH30230 Dry Area Painting - Primer 4.00 25-Nov-14 29-Nov-14 09-Dec-14 13-Dec-14 96.00 0% 0% 0.00
DHFSH30260 Dry Area Painting - Stucco 6.00 30-Nov-14 07-Dec-14 14-Dec-14 20-Dec-14 96.00 0% 0% 0.00
DHFSH30290 Dry Area False Ceiling Suspension 6.00 17-Dec-14 24-Dec-14 14-Feb-15 21-Feb-15 -23.00 0% 0% 0.00
DHFSH30610 GRP Lining For the Water Tank 20.00 19-Feb-15 14-Mar-15 19-Apr-15 11-May-15 103.00 0% 0% 0.00
DHFSH30350 Dry Area False Ceiling Tiling / Boarding 5.00 24-Feb-15 01-Mar-15 28-May-15 02-Jun-15 -43.00 0% 0% 0.00
DHFSH30400 Dry Area Painting - 1st Coat 5.00 02-Mar-15 07-Mar-15 03-Jun-15 08-Jun-15 -43.00 0% 0% 0.00
DHFSH30450 Dry Area Polyurethene Abrasion resistant Flooring 5.00 22-Mar-15 26-Mar-15 09-Jun-15 14-Jun-15 -34.00 0% 0% 0.00
DHFSH30620 Ladder for Tank 7.00 28-Mar-15 04-Apr-15 15-Jun-15 22-Jun-15 113.00 0% 0% 0.00
DHFSH30430 Installation of Timber Doors & Ironmongery 5.00 25-Jul-15 29-Jul-15 21-Sep-15 28-Sep-15 -12.00 0% 0% 0.00
DHFSH30500 Paint Final Coat 6.00 04-Oct-15 10-Oct-15 03-Dec-15 09-Dec-15 -50.00 0% 0% 0.00
Lift Lobby / Corridor 167.00 25-Nov-14 03-Jun-15 09-Dec-14 23-Jun-15 83.00 0% 0% 0.00
DHFSH30240 Corridor/Lift Lobby Floor Screed 4.00 25-Nov-14 29-Nov-14 09-Dec-14 13-Dec-14 43.00 0% 0% 0.00
DHFSH30270 Lift Lobby Painting - Primer & Stucco 6.00 30-Nov-14 07-Dec-14 14-Dec-14 20-Dec-14 43.00 0% 0% 0.00
DHFSH30310 Lift Lobby False Ceiling Suspension 6.00 03-Jan-15 10-Jan-15 01-Mar-15 08-Mar-15 -16.00 0% 0% 0.00
DHFSH30360 Lift Lobby False Ceiling Tiling / Boarding 5.00 24-Feb-15 01-Mar-15 28-May-15 02-Jun-15 15.00 0% 0% 0.00
DHFSH30410 Lift Lobby Painting - 1st Coat 6.00 02-Mar-15 08-Mar-15 03-Jun-15 09-Jun-15 15.00 0% 0% 0.00
DHFSH30440 Installation of Steel Doors & Windows 3.00 01-Jun-15 03-Jun-15 09-Jun-15 11-Jun-15 -7.00 0% 0% 0.00
DHFSH30470 Lift Lobby Flooring 6.00 29-Mar-15 04-Apr-15 10-Jun-15 16-Jun-15 83.00 0% 0% 0.00
DHFSH30490 Utility Rooms- Epoxy Flooring 6.00 05-Apr-15 11-Apr-15 17-Jun-15 23-Jun-15 83.00 0% 0% 0.00
Staircase 171.00 17-Nov-14 14-Jun-15 30-Nov-14 20-Jun-15 22.00 0% 0% 0.00
DHFSH30200 Staircase Plastering 4.00 17-Nov-14 20-Nov-14 30-Nov-14 04-Dec-14 145.00 0% 0% 0.00
DHFSH30280 Staircase Painting - Primer & Stucco 6.00 08-Dec-14 14-Dec-14 21-Dec-14 27-Dec-14 132.00 0% 0% 0.00
DHFSH30320 Staircase Handrail Fixing 3.00 28-Feb-15 03-Mar-15 11-Jan-15 13-Jan-15 140.00 0% 0% 0.00
DHFSH30330 Staircase Painting 1st Coat 3.00 03-Mar-15 07-Mar-15 22-Mar-15 25-Mar-15 83.00 0% 0% 0.00
DHFSH30340 Staircase Final Painting 5.00 07-Jun-15 11-Jun-15 13-Jun-15 17-Jun-15 22.00 0% 0% 0.00
DHFSH30380 Staircase Epoxy Flooring 2.00 13-Jun-15 14-Jun-15 18-Jun-15 20-Jun-15 22.00 0% 0% 0.00
General 396.00 17-Sep-14 21-Nov-15 01-Oct-14 19-Jan-16 -50.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - L30
Tower Crane Jump
Construction of Horizontals - L30 (Mech Floor)
Construction of Verticals - L30 (Mech Floor)
Stair # 1
Stair # 2
Service Area Civil Works
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
GRP Lining For the Water Tank
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Polyurethene Abrasion resistant Flooring
Ladder for Tank
Installation of Timber Doors & Ironmongery
Paint Final Coat
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 41 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHSTR30000 Access from Structure 0.00 17-Sep-14 01-Oct-14 -5.00 100% 0% 0.00
DHFSH30510 Snagging & De-Snagging 12.00 08-Nov-15 21-Nov-15 06-Jan-16 19-Jan-16 -50.00 0% 0% 0.00
MEP - LEVEL 30 515.00 18-Aug-14 20-Sep-15 17-Aug-14 A 21-Nov-15 -41.00 20.3% 0% 0.00
DHMEP30000 Embeded Conduits & Boxex - Concrete Works 6.00 18-Aug-14 24-Aug-14 17-Aug-14 A 22-Aug-14 A 100% 100% 0.00
DHMEP30100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C18a-bSlienpg- 1, 4Wiring et1c1-Oct-14 01-Oct-14 23-Oct-14 -5.00 61.11% 0% 0.00
DHMEP30130 Cable Trays & Cable Trunking 6.00 27-Oct-14 02-Nov-14 09-Nov-14 15-Nov-14 52.00 0% 0% 0.00
DHMEP30120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 01-Nov-14 06-Nov-14 13-Nov-14 19-Nov-14 43.00 0% 0% 0.00
DHMEP30610 Install FAHU's 20.00 21-Dec-14 13-Jan-15 22-Dec-14 14-Jan-15 5.00 0% 0% 0.00
DHMEP30110 MEP Works in Risers& Clearance 6.00 15-Dec-14 21-Dec-14 24-Jan-15 29-Jan-15 -33.00 0% 0% 0.00
DHMEP30630 Flushing 1st Loop - Upto L30 25.00 14-Jan-15 11-Feb-15 15-Jan-15 12-Feb-15 5.00 0% 0% 0.00
DHMEP30620 Ducting ,Cabling,Wiring& Connections 30.00 14-Jan-15 17-Feb-15 15-Jan-15 18-Feb-15 40.00 0% 0% 0.00
DHMEP30160 Pressure Testing of Pipes 12.00 05-Feb-15 18-Feb-15 05-Apr-15 18-Apr-15 -14.00 0% 0% 0.00
DHMEP30600 Installation of Water Tanks ,Pumps,,Extract Fans,Pressurization 4F5a.0n0s 28-Dec-14 18-Feb-15 25-Feb-15 18-Apr-15 -50.00 0% 0% 0.00
DHMEP30140 Chiller Installation & Wiring,Cable Pulling,Plenum Boxes &fire Sp3r0in.0k0lers20-Jan-15 23-Feb-15 22-Apr-15 27-May-15 -43.00 0% 0% 0.00
DHMEP30150 MEP Final Fixes 6.00 05-Aug-15 11-Aug-15 05-Oct-15 11-Oct-15 -17.00 0% 0% 0.00
DHMEP06420 Sanitary ware /Toilet accessories 6.00 09-Aug-15 15-Aug-15 08-Oct-15 15-Oct-15 -17.00 0% 0% 0.00
DHMEP30200 Pre-Testing & Commissioning 7.00 13-Sep-15 20-Sep-15 14-Nov-15 21-Nov-15 -41.00 0% 0% 0.00
LEVELS 31 - 61 599.00 12-Aug-14 26-Jan-16 14-Aug-14 A 07-Mar-16 -32.00 8.37% 7.52% 0.90
LEVEL 31 534.00 12-Aug-14 07-Sep-15 14-Aug-14 A 22-Dec-15 -45.00 42.62% 38.85% 0.91
STRUCTURAL WORKS - LEVEL 31 19.00 12-Aug-14 02-Sep-14 14-Aug-14 A 02-Sep-14 A 100% 100% 1.00
DHCWA32100 Core Wall - L31 6.00 12-Aug-14 18-Aug-14 14-Aug-14 A 17-Aug-14 A 100% 100% 1.00
DHSLA31100 Construction of Horizontals - L31 4.00 27-Aug-14 31-Aug-14 29-Aug-14 A 31-Aug-14 A 100% 100% 1.00
DHCWA32110 Construction of Verticals - L31 2.00 01-Sep-14 02-Sep-14 31-Aug-14 A 02-Sep-14 A 100% 100% 1.00
STAIRCASES 4.00 30-Oct-14 03-Nov-14 04-Nov-14 08-Nov-14 47.00 0% 0% 0.00
A1800 Stair # 1 4.00 30-Oct-14 03-Nov-14 04-Nov-14 08-Nov-14 11.00 0% 0% 0.00
A1810 Stair # 2 3.00 01-Nov-14 03-Nov-14 05-Nov-14 08-Nov-14 47.00 0% 0% 0.00
FINISHES WORKS - LEVEL 31 299.00 22-Sep-14 07-Sep-15 21-Sep-14 A 27-Sep-15 28.00 0% 0% 0.00
Dry area 263.00 19-Oct-14 24-Aug-15 02-Nov-14 10-Sep-15 28.00 0% 0% 0.00
DHFSH31100 Block Work in Dry Area 6.00 19-Oct-14 26-Oct-14 02-Nov-14 08-Nov-14 -5.00 0% 0% 0.00
DHFSH31120 Marking,Cutting & Chasing - Dry Area 4.00 27-Oct-14 30-Oct-14 09-Nov-14 12-Nov-14 46.00 0% 0% 0.00
DHFSH31130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 01-Nov-14 04-Nov-14 13-Nov-14 17-Nov-14 48.00 0% 0% 0.00
DHFSH31160 Plaster in Dry Area 8.00 08-Nov-14 16-Nov-14 20-Nov-14 29-Nov-14 46.00 0% 0% 0.00
DHMEP31190 Dry Area Floor Screed 7.00 17-Nov-14 24-Nov-14 30-Nov-14 08-Dec-14 46.00 0% 0% 0.00
DHFSH31230 Dry Area Painting - Primer 4.00 25-Nov-14 29-Nov-14 09-Dec-14 13-Dec-14 104.00 0% 0% 0.00
DHFSH31260 Dry Area Painting - Stucco 6.00 30-Nov-14 07-Dec-14 14-Dec-14 20-Dec-14 104.00 0% 0% 0.00
DHFSH31290 Dry Area False Ceiling Suspension 6.00 22-Dec-14 29-Dec-14 18-Feb-15 25-Feb-15 -23.00 0% 0% 0.00
DHFSH31350 Dry Area False Ceiling Tiling / Boarding 5.00 05-Mar-15 10-Mar-15 07-Jun-15 11-Jun-15 -43.00 0% 0% 0.00
DHFSH31400 Dry Area Painting - 1st Coat 5.00 11-Mar-15 16-Mar-15 13-Jun-15 17-Jun-15 -43.00 0% 0% 0.00
DHFSH31450 Dry Area Flooring 5.00 26-Mar-15 31-Mar-15 18-Jun-15 23-Jun-15 -38.00 0% 0% 0.00
DHFSH31430 Installation of Timber Doors & Ironmongery 5.00 21-Jul-15 26-Jul-15 06-Aug-15 12-Aug-15 -14.00 0% 0% 0.00
DHFSH31802 Installation of Wardrobe 12.00 22-Jul-15 04-Aug-15 08-Aug-15 22-Aug-15 -14.00 0% 0% 0.00
DHFSH31500 Paint Final Coat 6.00 18-Aug-15 24-Aug-15 03-Sep-15 10-Sep-15 28.00 0% 0% 0.00
Wet area 245.00 19-Oct-14 03-Aug-15 02-Nov-14 20-Aug-15 -5.00 0% 0% 0.00
DHFSH31110 Block Work in Wet Area 6.00 19-Oct-14 26-Oct-14 02-Nov-14 08-Nov-14 46.00 0% 0% 0.00
DHFSH31140 Marking,Cutting & Chasing - Wet Area 4.00 27-Oct-14 30-Oct-14 09-Nov-14 12-Nov-14 46.00 0% 0% 0.00
DHFSH31150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 01-Nov-14 04-Nov-14 13-Nov-14 17-Nov-14 51.00 0% 0% 0.00
DHMEP31170 Plaster in Wet Area 4.00 08-Nov-14 11-Nov-14 20-Nov-14 24-Nov-14 49.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Access from Structure
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Install FAHU's
MEP Works in Risers& Clearance
Flushing 1st Loop - Upto L30
Ducting ,Cabling,Wiring& Connections
Pressure Testing of Pipes
Installation of Water Tanks ,Pumps,,Extract Fans,Pressurization Fans
Chiller Installation & Wiring,Cable Pulling,Plenum Boxes &fire Sprinklers
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - L31
Construction of Horizontals - L31
Construction of Verticals - L31
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 42 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHMEP31180 Wet Area Wall Tiling 6.00 17-Dec-14 24-Dec-14 22-Jan-15 28-Jan-15 1.00 0% 0% 0.00
DHFSH31300 Wet Area False Ceiling Suspension 5.00 29-Dec-14 05-Jan-15 25-Feb-15 03-Mar-15 -15.00 0% 0% 0.00
DHFSH31370 Wet Area False Ceiling Tiling/Boarding 4.00 28-Feb-15 03-Mar-15 15-Mar-15 19-Mar-15 2.00 0% 0% 0.00
DHFSH31210 Wet Area Waterproofing 4.00 04-Mar-15 08-Mar-15 19-Mar-15 24-Mar-15 2.00 0% 0% 0.00
DHFSH31220 Wet Area Floor Screed 4.00 09-Mar-15 12-Mar-15 24-Mar-15 29-Mar-15 2.00 0% 0% 0.00
DHFSH31250 Wet Area Floor Tiling 5.00 14-Mar-15 18-Mar-15 29-Mar-15 04-Apr-15 2.00 0% 0% 0.00
DHFSH06730 Cabinet Carcass 4.00 19-Mar-15 23-Mar-15 07-Apr-15 11-Apr-15 -1.00 0% 0% 0.00
DHFSH31420 Installation of Shower Enclosure 4.00 26-Jul-15 29-Jul-15 11-Aug-15 16-Aug-15 -4.00 0% 0% 0.00
DHFSH31390 Installation of Vanity Counters & Tops 5.00 27-Jul-15 01-Aug-15 12-Aug-15 18-Aug-15 -3.00 0% 0% 0.00
DHFSH31800 Installation of Kitchen Cabinet 12.00 21-Jul-15 03-Aug-15 06-Aug-15 20-Aug-15 -14.00 0% 0% 0.00
Lift Lobby / Corridor 179.00 25-Nov-14 07-Jun-15 09-Dec-14 07-Jul-15 75.00 0% 0% 0.00
DHFSH31240 Corridor/Lift Lobby Floor Screed 4.00 25-Nov-14 29-Nov-14 09-Dec-14 13-Dec-14 46.00 0% 0% 0.00
DHFSH31270 Lift Lobby Painting - Primer & Stucco 6.00 30-Nov-14 07-Dec-14 14-Dec-14 20-Dec-14 46.00 0% 0% 0.00
DHFSH31310 Lift Lobby False Ceiling Suspension 6.00 06-Jan-15 13-Jan-15 04-Mar-15 11-Mar-15 -16.00 0% 0% 0.00
DHFSH31360 Lift Lobby False Ceiling Tiling / Boarding 5.00 28-Feb-15 04-Mar-15 15-Mar-15 21-Mar-15 81.00 0% 0% 0.00
DHFSH31410 Lift Lobby Painting - 1st Coat 6.00 05-Mar-15 11-Mar-15 07-Jun-15 13-Jun-15 15.00 0% 0% 0.00
DHFSH31440 Installation of Steel Doors & Windows 3.00 04-Jun-15 07-Jun-15 18-Jun-15 21-Jun-15 -12.00 0% 0% 0.00
DHFSH31470 Lift Lobby Flooring 6.00 01-Apr-15 07-Apr-15 24-Jun-15 30-Jun-15 75.00 0% 0% 0.00
DHFSH31490 Utility Rooms- Epoxy Flooring 6.00 08-Apr-15 14-Apr-15 01-Jul-15 07-Jul-15 75.00 0% 0% 0.00
Staircase 179.00 17-Nov-14 16-Jun-15 30-Nov-14 29-Jun-15 16.00 0% 0% 0.00
DHFSH31200 Staircase Plastering 4.00 17-Nov-14 20-Nov-14 30-Nov-14 04-Dec-14 148.00 0% 0% 0.00
DHFSH31280 Staircase Painting - Primer & Stucco 6.00 08-Dec-14 14-Dec-14 21-Dec-14 27-Dec-14 135.00 0% 0% 0.00
DHFSH31320 Staircase Handrail Fixing 3.00 03-Mar-15 07-Mar-15 14-Jan-15 17-Jan-15 140.00 0% 0% 0.00
DHFSH31330 Staircase Painting 1st Coat 3.00 17-Mar-15 19-Mar-15 18-Jun-15 21-Jun-15 11.00 0% 0% 0.00
DHFSH31340 Staircase Final Painting 5.00 08-Jun-15 13-Jun-15 22-Jun-15 27-Jun-15 16.00 0% 0% 0.00
DHFSH31380 Staircase Epoxy Flooring 2.00 15-Jun-15 16-Jun-15 28-Jun-15 29-Jun-15 16.00 0% 0% 0.00
General 299.00 22-Sep-14 07-Sep-15 21-Sep-14 A 27-Sep-15 28.00 0% 0% 0.00
DHSTR31000 Access from Structure 0.00 22-Sep-14 21-Sep-14 A 100% 100% 0.00
DHFSH31510 Snagging & De-Snagging 12.00 25-Aug-15 07-Sep-15 10-Sep-15 27-Sep-15 28.00 0% 0% 0.00
MEP - LEVEL 31 534.00 28-Aug-14 17-Aug-15 29-Aug-14 A 22-Dec-15 -63.00 15.54% 6.3% 0.41
DHMEP31000 Embeded Conduits & Boxex - Concrete Works 3.00 28-Aug-14 31-Aug-14 29-Aug-14 A 31-Aug-14 A 100% 100% 0.00
DHMEP31100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C22a-bSlienpg- 1, 4Wiring et1c4-Oct-14 22-Sep-14 A 20-Oct-14 -5.00 44.44% 18% 0.41
DHMEP31130 Cable Trays & Cable Trunking 6.00 27-Oct-14 02-Nov-14 09-Nov-14 15-Nov-14 56.00 0% 0% 0.00
DHMEP31120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 01-Nov-14 06-Nov-14 13-Nov-14 19-Nov-14 46.00 0% 0% 0.00
DHMEP31160 Pressure Testing of Pipes 12.00 08-Nov-14 20-Nov-14 20-Nov-14 04-Dec-14 73.00 0% 0% 0.00
DHMEP31110 MEP Works in Risers& Clearance 5.00 22-Dec-14 27-Dec-14 28-Sep-14 A 04-Feb-15 -33.00 0% 11% 0.00
DHMEP31140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es21-Feb-15 26-Feb-15 08-Mar-15 15-Mar-15 -7.00 0% 0% 0.00
DHMEP31150 MEP Final Fixes 6.00 30-Jul-15 05-Aug-15 16-Aug-15 23-Aug-15 25.00 0% 0% 0.00
DHMEP06430 Sanitary ware /Toilet accessories 6.00 03-Aug-15 09-Aug-15 19-Aug-15 26-Aug-15 28.00 0% 0% 0.00
DHMEP31200 Pre-Testing & Commissioning 7.00 10-Aug-15 17-Aug-15 26-Aug-15 03-Sep-15 28.00 0% 0% 0.00
DHMEP31010 Busbar - L31to L35 12.00 14-Jun-15 27-Jun-15 09-Dec-15 22-Dec-15 -144.00 0% 0% 0.00
LEVEL 32 495.00 19-Aug-14 13-Sep-15 19-Aug-14 A 09-Nov-15 -6.00 38.69% 36.32% 0.94
STRUCTURAL WORKS - LEVEL 32 18.00 19-Aug-14 08-Sep-14 19-Aug-14 A 09-Sep-14 A 100% 100% 1.00
DHCWA33100 Core Wall - L32 4.00 19-Aug-14 23-Aug-14 19-Aug-14 A 24-Aug-14 A 100% 100% 1.00
DHSLA32100 Construction of Horizontals - L32 4.00 02-Sep-14 06-Sep-14 02-Sep-14 A 07-Sep-14 A 100% 100% 1.00
DHCWA33110 Construction of Verticals - L32 2.00 07-Sep-14 08-Sep-14 08-Sep-14 A 09-Sep-14 A 100% 100% 1.00
STAIRCASES 4.00 05-Nov-14 09-Nov-14 10-Nov-14 13-Nov-14 45.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Shower Enclosure
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - L32
Construction of Horizontals - L32
Construction of Verticals - L32
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 43 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
A1820 Stair # 1 4.00 05-Nov-14 09-Nov-14 10-Nov-14 13-Nov-14 10.00 0% 0% 0.00
A1830 Stair # 2 3.00 06-Nov-14 09-Nov-14 11-Nov-14 13-Nov-14 45.00 0% 0% 0.00
FINISHES WORKS - LEVEL 32 336.00 28-Sep-14 13-Sep-15 01-Oct-14 09-Nov-15 -6.00 0% 0% 0.00
Dry area 296.00 23-Oct-14 30-Aug-15 06-Nov-14 26-Oct-15 -6.00 0% 0% 0.00
DHFSH32100 Block Work in Dry Area 6.00 23-Oct-14 30-Oct-14 06-Nov-14 12-Nov-14 -5.00 0% 0% 0.00
DHFSH32120 Marking,Cutting & Chasing - Dry Area 4.00 01-Nov-14 04-Nov-14 13-Nov-14 17-Nov-14 45.00 0% 0% 0.00
DHFSH32130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 05-Nov-14 09-Nov-14 18-Nov-14 22-Nov-14 47.00 0% 0% 0.00
DHFSH32160 Plaster in Dry Area 8.00 12-Nov-14 20-Nov-14 25-Nov-14 04-Dec-14 45.00 0% 0% 0.00
DHMEP32190 Dry Area Floor Screed 7.00 22-Nov-14 29-Nov-14 06-Dec-14 13-Dec-14 45.00 0% 0% 0.00
DHFSH32230 Dry Area Painting - Primer 4.00 30-Nov-14 04-Dec-14 14-Dec-14 17-Dec-14 105.00 0% 0% 0.00
DHFSH32260 Dry Area Painting - Stucco 6.00 06-Dec-14 11-Dec-14 18-Dec-14 24-Dec-14 105.00 0% 0% 0.00
DHFSH32290 Dry Area False Ceiling Suspension 6.00 27-Dec-14 04-Jan-15 23-Feb-15 02-Mar-15 -23.00 0% 0% 0.00
DHFSH32350 Dry Area False Ceiling Tiling / Boarding 5.00 03-Mar-15 08-Mar-15 18-Mar-15 24-Mar-15 30.00 0% 0% 0.00
DHFSH32400 Dry Area Painting - 1st Coat 5.00 17-Mar-15 22-Mar-15 18-Jun-15 23-Jun-15 -43.00 0% 0% 0.00
DHFSH32450 Dry Area Flooring 5.00 31-Mar-15 05-Apr-15 24-Jun-15 29-Jun-15 -39.00 0% 0% 0.00
DHFSH32430 Installation of Timber Doors & Ironmongery 5.00 27-Jul-15 01-Aug-15 12-Aug-15 18-Aug-15 -14.00 0% 0% 0.00
DHFSH32802 Installation of Wardrobe 12.00 27-Jul-15 09-Aug-15 12-Aug-15 26-Aug-15 -14.00 0% 0% 0.00
DHFSH32500 Paint Final Coat 6.00 24-Aug-15 30-Aug-15 20-Oct-15 26-Oct-15 -6.00 0% 0% 0.00
Wet area 274.00 23-Oct-14 06-Aug-15 06-Nov-14 29-Sep-15 -35.00 0% 0% 0.00
DHFSH32110 Block Work in Wet Area 6.00 23-Oct-14 30-Oct-14 06-Nov-14 12-Nov-14 45.00 0% 0% 0.00
DHFSH32140 Marking,Cutting & Chasing - Wet Area 4.00 01-Nov-14 04-Nov-14 13-Nov-14 17-Nov-14 45.00 0% 0% 0.00
DHFSH32150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 05-Nov-14 09-Nov-14 18-Nov-14 22-Nov-14 51.00 0% 0% 0.00
DHMEP32170 Plaster in Wet Area 4.00 12-Nov-14 16-Nov-14 25-Nov-14 29-Nov-14 49.00 0% 0% 0.00
DHMEP32180 Wet Area Wall Tiling 6.00 22-Dec-14 29-Dec-14 27-Jan-15 02-Feb-15 1.00 0% 0% 0.00
DHFSH32300 Wet Area False Ceiling Suspension 5.00 04-Jan-15 10-Jan-15 02-Mar-15 08-Mar-15 -16.00 0% 0% 0.00
DHFSH32370 Wet Area False Ceiling Tiling/Boarding 4.00 03-Mar-15 07-Mar-15 18-Mar-15 23-Mar-15 3.00 0% 0% 0.00
DHFSH32210 Wet Area Waterproofing 4.00 08-Mar-15 11-Mar-15 23-Mar-15 28-Mar-15 3.00 0% 0% 0.00
DHFSH32220 Wet Area Floor Screed 4.00 12-Mar-15 16-Mar-15 28-Mar-15 01-Apr-15 3.00 0% 0% 0.00
DHFSH32250 Wet Area Floor Tiling 5.00 17-Mar-15 22-Mar-15 01-Apr-15 07-Apr-15 3.00 0% 0% 0.00
DHFSH06740 Cabinet Carcass 4.00 24-Mar-15 28-Mar-15 12-Apr-15 15-Apr-15 -1.00 0% 0% 0.00
DHFSH32390 Installation of Vanity Counters & Tops 5.00 02-Aug-15 06-Aug-15 18-Aug-15 24-Aug-15 -5.00 0% 0% 0.00
DHFSH32800 Installation of Kitchen Cabinet 12.00 25-Jul-15 06-Aug-15 10-Aug-15 24-Aug-15 -14.00 0% 0% 0.00
DHFSH32420 Installation of Shower Enclosure 4.00 01-Aug-15 04-Aug-15 26-Sep-15 29-Sep-15 -38.00 0% 0% 0.00
Lift Lobby / Corridor 180.00 30-Nov-14 10-Jun-15 14-Dec-14 13-Jul-15 72.00 0% 0% 0.00
DHFSH32240 Corridor/Lift Lobby Floor Screed 4.00 30-Nov-14 04-Dec-14 14-Dec-14 17-Dec-14 45.00 0% 0% 0.00
DHFSH32270 Lift Lobby Painting - Primer & Stucco 6.00 06-Dec-14 11-Dec-14 18-Dec-14 24-Dec-14 45.00 0% 0% 0.00
DHFSH32310 Lift Lobby False Ceiling Suspension 6.00 10-Jan-15 17-Jan-15 08-Mar-15 15-Mar-15 -16.00 0% 0% 0.00
DHFSH32360 Lift Lobby False Ceiling Tiling / Boarding 5.00 03-Mar-15 08-Mar-15 18-Mar-15 24-Mar-15 81.00 0% 0% 0.00
DHFSH32410 Lift Lobby Painting - 1st Coat 6.00 09-Mar-15 15-Mar-15 10-Jun-15 16-Jun-15 15.00 0% 0% 0.00
DHFSH32440 Installation of Steel Doors & Windows 3.00 08-Jun-15 10-Jun-15 24-Jun-15 27-Jun-15 -14.00 0% 0% 0.00
DHFSH32470 Lift Lobby Flooring 6.00 06-Apr-15 12-Apr-15 30-Jun-15 06-Jul-15 72.00 0% 0% 0.00
DHFSH32490 Utility Rooms- Epoxy Flooring 6.00 13-Apr-15 19-Apr-15 07-Jul-15 13-Jul-15 72.00 0% 0% 0.00
Staircase 180.00 22-Nov-14 18-Jun-15 06-Dec-14 05-Jul-15 16.00 0% 0% 0.00
DHFSH32200 Staircase Plastering 4.00 22-Nov-14 25-Nov-14 06-Dec-14 09-Dec-14 147.00 0% 0% 0.00
DHFSH32280 Staircase Painting - Primer & Stucco 6.00 13-Dec-14 18-Dec-14 25-Dec-14 31-Dec-14 134.00 0% 0% 0.00
DHFSH32320 Staircase Handrail Fixing 3.00 07-Mar-15 10-Mar-15 18-Jan-15 20-Jan-15 140.00 0% 0% 0.00
DHFSH32330 Staircase Painting 1st Coat 3.00 23-Mar-15 25-Mar-15 24-Jun-15 27-Jun-15 9.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Installation of Shower Enclosure
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 44 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH32340 Staircase Final Painting 5.00 11-Jun-15 16-Jun-15 28-Jun-15 02-Jul-15 16.00 0% 0% 0.00
DHFSH32380 Staircase Epoxy Flooring 2.00 17-Jun-15 18-Jun-15 04-Jul-15 05-Jul-15 16.00 0% 0% 0.00
General 336.00 28-Sep-14 13-Sep-15 01-Oct-14 09-Nov-15 -6.00 0% 0% 0.00
DHSTR32000 Access from Structure 0.00 28-Sep-14 01-Oct-14 -3.00 100% 0% 0.00
DHFSH32510 Snagging & De-Snagging 12.00 31-Aug-15 13-Sep-15 27-Oct-15 09-Nov-15 -6.00 0% 0% 0.00
MEP - LEVEL 32 477.00 03-Sep-14 23-Aug-15 02-Sep-14 A 19-Oct-15 -6.00 5.83% 0% 0.00
DHMEP32000 Embeded Conduits & Boxex - Concrete Works 3.00 03-Sep-14 06-Sep-14 02-Sep-14 A 07-Sep-14 A 100% 100% 0.00
DHMEP32100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C28a-bSlienpg- 1, 4Wiring et2c0-Oct-14 06-Oct-14 27-Oct-14 -5.00 16.67% 0% 0.00
DHMEP32130 Cable Trays & Cable Trunking 6.00 01-Nov-14 06-Nov-14 13-Nov-14 19-Nov-14 56.00 0% 0% 0.00
DHMEP32120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 05-Nov-14 11-Nov-14 18-Nov-14 24-Nov-14 45.00 0% 0% 0.00
DHMEP32160 Pressure Testing of Pipes 12.00 12-Nov-14 25-Nov-14 25-Nov-14 09-Dec-14 72.00 0% 0% 0.00
DHMEP32110 MEP Works in Risers& Clearance 5.00 28-Dec-14 03-Jan-15 05-Feb-15 10-Feb-15 -33.00 0% 0% 0.00
DHMEP32140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es24-Feb-15 02-Mar-15 11-Mar-15 18-Mar-15 -7.00 0% 0% 0.00
DHMEP32150 MEP Final Fixes 6.00 05-Aug-15 11-Aug-15 30-Sep-15 06-Oct-15 -9.00 0% 0% 0.00
DHMEP06440 Sanitary ware /Toilet accessories 6.00 09-Aug-15 15-Aug-15 04-Oct-15 10-Oct-15 -6.00 0% 0% 0.00
DHMEP32200 Pre-Testing & Commissioning 7.00 16-Aug-15 23-Aug-15 11-Oct-15 19-Oct-15 -6.00 0% 0% 0.00
LEVEL 33 495.00 24-Aug-14 19-Sep-15 24-Aug-14 A 12-Nov-15 -6.00 36.35% 36.35% 1.00
STRUCTURAL WORKS - LEVEL 33 19.00 24-Aug-14 14-Sep-14 24-Aug-14 A 14-Sep-14 A 100% 100% 1.00
DHCWA34100 Core Wall - L33 5.00 24-Aug-14 28-Aug-14 24-Aug-14 A 28-Aug-14 A 100% 100% 1.00
DHSLA33100 Construction of Horizontals - L33 4.00 08-Sep-14 11-Sep-14 10-Sep-14 A 12-Sep-14 A 100% 100% 1.00
DHCWA34110 Construction of Verticals - L33 2.00 13-Sep-14 14-Sep-14 13-Sep-14 A 14-Sep-14 A 100% 100% 1.00
STAIRCASES 4.00 10-Nov-14 13-Nov-14 15-Nov-14 18-Nov-14 44.00 0% 0% 0.00
A1840 Stair # 1 4.00 10-Nov-14 13-Nov-14 15-Nov-14 18-Nov-14 10.00 0% 0% 0.00
A1850 Stair # 2 3.00 11-Nov-14 13-Nov-14 16-Nov-14 18-Nov-14 44.00 0% 0% 0.00
FINISHES WORKS - LEVEL 33 334.00 06-Oct-14 19-Sep-15 09-Oct-14 12-Nov-15 -6.00 0% 0% 0.00
Dry area 295.00 29-Oct-14 05-Sep-15 11-Nov-14 29-Oct-15 -6.00 0% 0% 0.00
DHFSH33100 Block Work in Dry Area 6.00 29-Oct-14 04-Nov-14 11-Nov-14 17-Nov-14 -5.00 0% 0% 0.00
DHFSH33120 Marking,Cutting & Chasing - Dry Area 4.00 05-Nov-14 09-Nov-14 18-Nov-14 22-Nov-14 44.00 0% 0% 0.00
DHFSH33130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 10-Nov-14 13-Nov-14 23-Nov-14 26-Nov-14 46.00 0% 0% 0.00
DHFSH33160 Plaster in Dry Area 8.00 17-Nov-14 25-Nov-14 30-Nov-14 09-Dec-14 44.00 0% 0% 0.00
DHMEP33190 Dry Area Floor Screed 7.00 26-Nov-14 04-Dec-14 10-Dec-14 17-Dec-14 44.00 0% 0% 0.00
DHFSH33230 Dry Area Painting - Primer 4.00 06-Dec-14 09-Dec-14 18-Dec-14 22-Dec-14 109.00 0% 0% 0.00
DHFSH33260 Dry Area Painting - Stucco 6.00 10-Dec-14 16-Dec-14 23-Dec-14 29-Dec-14 109.00 0% 0% 0.00
DHFSH33290 Dry Area False Ceiling Suspension 6.00 31-Dec-14 08-Jan-15 28-Feb-15 07-Mar-15 -23.00 0% 0% 0.00
DHFSH33350 Dry Area False Ceiling Tiling / Boarding 5.00 21-Mar-15 25-Mar-15 22-Jun-15 27-Jun-15 -43.00 0% 0% 0.00
DHFSH33400 Dry Area Painting - 1st Coat 5.00 26-Mar-15 31-Mar-15 28-Jun-15 02-Jul-15 -43.00 0% 0% 0.00
DHFSH33450 Dry Area Flooring 5.00 05-Apr-15 09-Apr-15 04-Jul-15 08-Jul-15 -43.00 0% 0% 0.00
DHFSH33430 Installation of Timber Doors & Ironmongery 5.00 02-Aug-15 06-Aug-15 18-Aug-15 24-Aug-15 -14.00 0% 0% 0.00
DHFSH33802 Installation of Wardrobe 12.00 01-Aug-15 13-Aug-15 17-Aug-15 31-Aug-15 -14.00 0% 0% 0.00
DHFSH33500 Paint Final Coat 6.00 30-Aug-15 05-Sep-15 24-Oct-15 29-Oct-15 -6.00 0% 0% 0.00
Wet area 273.00 29-Oct-14 12-Aug-15 11-Nov-14 03-Oct-15 -35.00 0% 0% 0.00
DHFSH33110 Block Work in Wet Area 6.00 29-Oct-14 04-Nov-14 11-Nov-14 17-Nov-14 44.00 0% 0% 0.00
DHFSH33140 Marking,Cutting & Chasing - Wet Area 4.00 05-Nov-14 09-Nov-14 18-Nov-14 22-Nov-14 44.00 0% 0% 0.00
DHFSH33150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 10-Nov-14 13-Nov-14 23-Nov-14 26-Nov-14 51.00 0% 0% 0.00
DHMEP33170 Plaster in Wet Area 4.00 17-Nov-14 20-Nov-14 30-Nov-14 04-Dec-14 49.00 0% 0% 0.00
DHMEP33180 Wet Area Wall Tiling 6.00 27-Dec-14 04-Jan-15 01-Feb-15 07-Feb-15 1.00 0% 0% 0.00
DHFSH33300 Wet Area False Ceiling Suspension 5.00 08-Jan-15 14-Jan-15 07-Mar-15 12-Mar-15 -17.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - L33
Construction of Horizontals - L33
Construction of Verticals - L33
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 45 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH33370 Wet Area False Ceiling Tiling/Boarding 4.00 07-Mar-15 10-Mar-15 23-Mar-15 28-Mar-15 3.00 0% 0% 0.00
DHFSH33210 Wet Area Waterproofing 4.00 11-Mar-15 15-Mar-15 28-Mar-15 01-Apr-15 3.00 0% 0% 0.00
DHFSH33220 Wet Area Floor Screed 4.00 16-Mar-15 19-Mar-15 01-Apr-15 06-Apr-15 3.00 0% 0% 0.00
DHFSH33250 Wet Area Floor Tiling 5.00 21-Mar-15 25-Mar-15 06-Apr-15 12-Apr-15 3.00 0% 0% 0.00
DHFSH06750 Cabinet Carcass 4.00 29-Mar-15 01-Apr-15 16-Apr-15 20-Apr-15 -1.00 0% 0% 0.00
DHFSH33800 Installation of Kitchen Cabinet 12.00 28-Jul-15 10-Aug-15 13-Aug-15 27-Aug-15 -14.00 0% 0% 0.00
DHFSH33390 Installation of Vanity Counters & Tops 5.00 08-Aug-15 12-Aug-15 24-Aug-15 30-Aug-15 -7.00 0% 0% 0.00
DHFSH33420 Installation of Shower Enclosure 4.00 06-Aug-15 10-Aug-15 29-Sep-15 03-Oct-15 -38.00 0% 0% 0.00
Lift Lobby / Corridor 184.00 06-Dec-14 14-Jun-15 18-Dec-14 25-Jul-15 66.00 0% 0% 0.00
DHFSH33240 Corridor/Lift Lobby Floor Screed 4.00 06-Dec-14 09-Dec-14 18-Dec-14 22-Dec-14 44.00 0% 0% 0.00
DHFSH33270 Lift Lobby Painting - Primer & Stucco 6.00 10-Dec-14 16-Dec-14 23-Dec-14 29-Dec-14 44.00 0% 0% 0.00
DHFSH33310 Lift Lobby False Ceiling Suspension 6.00 14-Jan-15 21-Jan-15 12-Mar-15 19-Mar-15 -17.00 0% 0% 0.00
DHFSH33360 Lift Lobby False Ceiling Tiling / Boarding 5.00 07-Mar-15 11-Mar-15 23-Mar-15 29-Mar-15 80.00 0% 0% 0.00
DHFSH33410 Lift Lobby Painting - 1st Coat 6.00 12-Mar-15 18-Mar-15 14-Jun-15 20-Jun-15 15.00 0% 0% 0.00
DHFSH33440 Installation of Steel Doors & Windows 3.00 11-Jun-15 14-Jun-15 04-Jul-15 06-Jul-15 -19.00 0% 0% 0.00
DHFSH33470 Lift Lobby Flooring 6.00 11-Apr-15 16-Apr-15 09-Jul-15 15-Jul-15 66.00 0% 0% 0.00
DHFSH33490 Utility Rooms- Epoxy Flooring 6.00 18-Apr-15 23-Apr-15 16-Jul-15 25-Jul-15 66.00 0% 0% 0.00
Staircase 184.00 26-Nov-14 22-Jun-15 10-Dec-14 14-Jul-15 13.00 0% 0% 0.00
DHFSH33200 Staircase Plastering 4.00 26-Nov-14 30-Nov-14 10-Dec-14 14-Dec-14 146.00 0% 0% 0.00
DHFSH33280 Staircase Painting - Primer & Stucco 6.00 17-Dec-14 23-Dec-14 30-Dec-14 06-Jan-15 133.00 0% 0% 0.00
DHFSH33320 Staircase Handrail Fixing 3.00 10-Mar-15 14-Mar-15 21-Jan-15 24-Jan-15 140.00 0% 0% 0.00
DHFSH33330 Staircase Painting 1st Coat 3.00 01-Apr-15 04-Apr-15 04-Jul-15 06-Jul-15 4.00 0% 0% 0.00
DHFSH33340 Staircase Final Painting 5.00 15-Jun-15 20-Jun-15 07-Jul-15 12-Jul-15 13.00 0% 0% 0.00
DHFSH33380 Staircase Epoxy Flooring 2.00 21-Jun-15 22-Jun-15 13-Jul-15 14-Jul-15 13.00 0% 0% 0.00
General 334.00 06-Oct-14 19-Sep-15 09-Oct-14 12-Nov-15 -6.00 0% 0% 0.00
DHSTR33000 Access from Structure 0.00 06-Oct-14 09-Oct-14 -2.00 0% 0% 0.00
DHFSH33510 Snagging & De-Snagging 12.00 06-Sep-15 19-Sep-15 31-Oct-15 12-Nov-15 -6.00 0% 0% 0.00
MEP - LEVEL 33 477.00 09-Sep-14 29-Aug-15 10-Sep-14 A 22-Oct-15 -6.00 0% 0% 0.00
DHMEP33000 Embeded Conduits & Boxex - Concrete Works 3.00 09-Sep-14 11-Sep-14 10-Sep-14 A 12-Sep-14 A 100% 100% 0.00
DHMEP33100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C07a-bOlicntg-1 ,4 Wiring et2c8-Oct-14 13-Oct-14 03-Nov-14 -5.00 0% 0% 0.00
DHMEP33130 Cable Trays & Cable Trunking 6.00 05-Nov-14 11-Nov-14 18-Nov-14 24-Nov-14 56.00 0% 0% 0.00
DHMEP33120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 10-Nov-14 16-Nov-14 23-Nov-14 29-Nov-14 44.00 0% 0% 0.00
DHMEP33160 Pressure Testing of Pipes 12.00 17-Nov-14 30-Nov-14 30-Nov-14 14-Dec-14 71.00 0% 0% 0.00
DHMEP33110 MEP Works in Risers& Clearance 5.00 04-Jan-15 08-Jan-15 11-Feb-15 16-Feb-15 -33.00 0% 0% 0.00
DHMEP33140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es28-Feb-15 05-Mar-15 16-Mar-15 23-Mar-15 -8.00 0% 0% 0.00
DHMEP33150 MEP Final Fixes 6.00 11-Aug-15 17-Aug-15 04-Oct-15 10-Oct-15 -9.00 0% 0% 0.00
DHMEP06450 Sanitary ware /Toilet accessories 6.00 15-Aug-15 20-Aug-15 07-Oct-15 14-Oct-15 -6.00 0% 0% 0.00
DHMEP33200 Pre-Testing & Commissioning 7.00 22-Aug-15 29-Aug-15 15-Oct-15 22-Oct-15 -6.00 0% 0% 0.00
LEVEL 34 495.00 30-Aug-14 22-Sep-15 30-Aug-14 A 16-Nov-15 -6.00 36.39% 36.39% 1.00
STRUCTURAL WORKS - LEVEL 34 25.00 30-Aug-14 18-Sep-14 30-Aug-14 A 21-Sep-14 A 100% 100% 1.00
DHCWA35100 Core Wall - L34 5.00 30-Aug-14 03-Sep-14 30-Aug-14 A 03-Sep-14 A 100% 100% 1.00
DHCWA35120 Tower Crane Jump 1.00 30-Aug-14 30-Aug-14 06-Sep-14 A 07-Sep-14 A 100% 100% 0.00
DHSLA34100 Construction of Horizontals - L34 4.00 13-Sep-14 16-Sep-14 15-Sep-14 A 18-Sep-14 A 100% 100% 1.00
DHCWA35110 Construction of Verticals - L34 2.00 17-Sep-14 18-Sep-14 20-Sep-14 A 21-Sep-14 A 100% 100% 1.00
STAIRCASES 4.00 16-Nov-14 19-Nov-14 20-Nov-14 24-Nov-14 42.00 0% 0% 0.00
A1860 Stair # 1 4.00 16-Nov-14 19-Nov-14 20-Nov-14 24-Nov-14 9.00 0% 0% 0.00
A1870 Stair # 2 3.00 17-Nov-14 19-Nov-14 22-Nov-14 24-Nov-14 42.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Kitchen Cabinet
Installation of Vanity Counters & Tops
Installation of Shower Enclosure
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - L34
Tower Crane Jump
Construction of Horizontals - L34
Construction of Verticals - L34
Stair # 1
Stair # 2
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 46 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
FINISHES WORKS - LEVEL 34 334.00 09-Oct-14 22-Sep-15 13-Oct-14 16-Nov-15 -6.00 0% 0% 0.00
Dry area 293.00 05-Nov-14 08-Sep-15 17-Nov-14 02-Nov-15 -6.00 0% 0% 0.00
DHFSH34100 Block Work in Dry Area 6.00 05-Nov-14 11-Nov-14 17-Nov-14 23-Nov-14 -5.00 0% 0% 0.00
DHFSH34120 Marking,Cutting & Chasing - Dry Area 4.00 12-Nov-14 16-Nov-14 24-Nov-14 27-Nov-14 42.00 0% 0% 0.00
DHFSH34130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 17-Nov-14 20-Nov-14 29-Nov-14 03-Dec-14 44.00 0% 0% 0.00
DHFSH34160 Plaster in Dry Area 8.00 24-Nov-14 03-Dec-14 07-Dec-14 15-Dec-14 42.00 0% 0% 0.00
DHMEP34190 Dry Area Floor Screed 7.00 04-Dec-14 11-Dec-14 16-Dec-14 23-Dec-14 42.00 0% 0% 0.00
DHFSH34230 Dry Area Painting - Primer 4.00 13-Dec-14 16-Dec-14 24-Dec-14 28-Dec-14 108.00 0% 0% 0.00
DHFSH34260 Dry Area Painting - Stucco 6.00 17-Dec-14 23-Dec-14 29-Dec-14 05-Jan-15 108.00 0% 0% 0.00
DHFSH34290 Dry Area False Ceiling Suspension 6.00 06-Jan-15 13-Jan-15 04-Mar-15 11-Mar-15 -23.00 0% 0% 0.00
DHFSH34350 Dry Area False Ceiling Tiling / Boarding 5.00 10-Mar-15 15-Mar-15 28-Mar-15 02-Apr-15 34.00 0% 0% 0.00
DHFSH34400 Dry Area Painting - 1st Coat 5.00 26-Mar-15 31-Mar-15 28-Jun-15 02-Jul-15 -39.00 0% 0% 0.00
DHFSH34450 Dry Area Flooring 5.00 09-Apr-15 14-Apr-15 08-Jul-15 13-Jul-15 -43.00 0% 0% 0.00
DHFSH34430 Installation of Timber Doors & Ironmongery 5.00 05-Aug-15 10-Aug-15 22-Aug-15 27-Aug-15 -14.00 0% 0% 0.00
DHFSH34802 Installation of Wardrobe 12.00 05-Aug-15 18-Aug-15 22-Aug-15 05-Sep-15 -14.00 0% 0% 0.00
DHFSH34500 Paint Final Coat 6.00 02-Sep-15 08-Sep-15 27-Oct-15 02-Nov-15 -6.00 0% 0% 0.00
Wet area 271.00 05-Nov-14 16-Aug-15 17-Nov-14 06-Oct-15 -35.00 0% 0% 0.00
DHFSH34110 Block Work in Wet Area 6.00 05-Nov-14 11-Nov-14 17-Nov-14 23-Nov-14 42.00 0% 0% 0.00
DHFSH34140 Marking,Cutting & Chasing - Wet Area 4.00 12-Nov-14 16-Nov-14 24-Nov-14 27-Nov-14 42.00 0% 0% 0.00
DHFSH34150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 17-Nov-14 20-Nov-14 29-Nov-14 03-Dec-14 50.00 0% 0% 0.00
DHMEP34170 Plaster in Wet Area 4.00 24-Nov-14 27-Nov-14 07-Dec-14 10-Dec-14 48.00 0% 0% 0.00
DHMEP34180 Wet Area Wall Tiling 6.00 31-Dec-14 08-Jan-15 05-Feb-15 11-Feb-15 1.00 0% 0% 0.00
DHFSH34300 Wet Area False Ceiling Suspension 5.00 13-Jan-15 19-Jan-15 11-Mar-15 17-Mar-15 -18.00 0% 0% 0.00
DHFSH34370 Wet Area False Ceiling Tiling/Boarding 4.00 10-Mar-15 14-Mar-15 28-Mar-15 01-Apr-15 3.00 0% 0% 0.00
DHFSH34210 Wet Area Waterproofing 4.00 15-Mar-15 18-Mar-15 01-Apr-15 06-Apr-15 3.00 0% 0% 0.00
DHFSH34220 Wet Area Floor Screed 4.00 19-Mar-15 23-Mar-15 06-Apr-15 11-Apr-15 3.00 0% 0% 0.00
DHFSH34250 Wet Area Floor Tiling 5.00 24-Mar-15 29-Mar-15 11-Apr-15 16-Apr-15 3.00 0% 0% 0.00
DHFSH06760 Cabinet Carcass 4.00 02-Apr-15 06-Apr-15 21-Apr-15 25-Apr-15 -1.00 0% 0% 0.00
DHFSH34800 Installation of Kitchen Cabinet 12.00 01-Aug-15 13-Aug-15 17-Aug-15 31-Aug-15 -14.00 0% 0% 0.00
DHFSH34390 Installation of Vanity Counters & Tops 5.00 11-Aug-15 16-Aug-15 27-Aug-15 02-Sep-15 -7.00 0% 0% 0.00
DHFSH34420 Installation of Shower Enclosure 4.00 10-Aug-15 13-Aug-15 03-Oct-15 06-Oct-15 -38.00 0% 0% 0.00
Lift Lobby / Corridor 183.00 13-Dec-14 17-Jun-15 24-Dec-14 29-Jul-15 64.00 0% 0% 0.00
DHFSH34240 Corridor/Lift Lobby Floor Screed 4.00 13-Dec-14 16-Dec-14 24-Dec-14 28-Dec-14 42.00 0% 0% 0.00
DHFSH34270 Lift Lobby Painting - Primer & Stucco 6.00 17-Dec-14 23-Dec-14 29-Dec-14 05-Jan-15 42.00 0% 0% 0.00
DHFSH34310 Lift Lobby False Ceiling Suspension 6.00 19-Jan-15 26-Jan-15 17-Mar-15 24-Mar-15 -18.00 0% 0% 0.00
DHFSH34360 Lift Lobby False Ceiling Tiling / Boarding 5.00 10-Mar-15 15-Mar-15 28-Mar-15 02-Apr-15 79.00 0% 0% 0.00
DHFSH34410 Lift Lobby Painting - 1st Coat 6.00 16-Mar-15 22-Mar-15 17-Jun-15 23-Jun-15 15.00 0% 0% 0.00
DHFSH34440 Installation of Steel Doors & Windows 3.00 15-Jun-15 17-Jun-15 07-Jul-15 09-Jul-15 -19.00 0% 0% 0.00
DHFSH34470 Lift Lobby Flooring 6.00 15-Apr-15 21-Apr-15 14-Jul-15 22-Jul-15 64.00 0% 0% 0.00
DHFSH34490 Utility Rooms- Epoxy Flooring 6.00 22-Apr-15 28-Apr-15 23-Jul-15 29-Jul-15 64.00 0% 0% 0.00
Staircase 182.00 04-Dec-14 25-Jun-15 16-Dec-14 20-Jul-15 13.00 0% 0% 0.00
DHFSH34200 Staircase Plastering 4.00 04-Dec-14 08-Dec-14 16-Dec-14 20-Dec-14 144.00 0% 0% 0.00
DHFSH34280 Staircase Painting - Primer & Stucco 6.00 24-Dec-14 30-Dec-14 06-Jan-15 12-Jan-15 131.00 0% 0% 0.00
DHFSH34320 Staircase Handrail Fixing 3.00 14-Mar-15 17-Mar-15 25-Jan-15 27-Jan-15 140.00 0% 0% 0.00
DHFSH34330 Staircase Painting 1st Coat 3.00 05-Apr-15 07-Apr-15 07-Jul-15 09-Jul-15 4.00 0% 0% 0.00
DHFSH34340 Staircase Final Painting 5.00 18-Jun-15 23-Jun-15 11-Jul-15 15-Jul-15 13.00 0% 0% 0.00
DHFSH34380 Staircase Epoxy Flooring 2.00 24-Jun-15 25-Jun-15 16-Jul-15 20-Jul-15 13.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Kitchen Cabinet
Installation of Vanity Counters & Tops
Installation of Shower Enclosure
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 47 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
General 334.00 09-Oct-14 22-Sep-15 13-Oct-14 16-Nov-15 -6.00 0% 0% 0.00
DHSTR34000 Access from Structure 0.00 09-Oct-14 13-Oct-14 1.00 0% 0% 0.00
DHFSH34510 Snagging & De-Snagging 12.00 09-Sep-15 22-Sep-15 03-Nov-15 16-Nov-15 -6.00 0% 0% 0.00
MEP - LEVEL 34 477.00 14-Sep-14 01-Sep-15 15-Sep-14 A 26-Oct-15 -6.00 0% 0% 0.00
DHMEP34000 Embeded Conduits & Boxex - Concrete Works 3.00 14-Sep-14 16-Sep-14 15-Sep-14 A 18-Sep-14 A 100% 100% 0.00
DHMEP34100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C14a-bOlicntg-1 ,4 Wiring et0c4-Nov-14 20-Oct-14 10-Nov-14 -5.00 0% 0% 0.00
DHMEP34130 Cable Trays & Cable Trunking 6.00 12-Nov-14 18-Nov-14 24-Nov-14 30-Nov-14 55.00 0% 0% 0.00
DHMEP34120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 17-Nov-14 23-Nov-14 29-Nov-14 06-Dec-14 42.00 0% 0% 0.00
DHMEP34160 Pressure Testing of Pipes 12.00 24-Nov-14 08-Dec-14 07-Dec-14 20-Dec-14 69.00 0% 0% 0.00
DHMEP34110 MEP Works in Risers& Clearance 5.00 10-Jan-15 14-Jan-15 17-Feb-15 22-Feb-15 -33.00 0% 0% 0.00
DHMEP34140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es03-Mar-15 09-Mar-15 21-Mar-15 28-Mar-15 -9.00 0% 0% 0.00
DHMEP34150 MEP Final Fixes 6.00 15-Aug-15 20-Aug-15 07-Oct-15 14-Oct-15 -9.00 0% 0% 0.00
DHMEP06460 Sanitary ware /Toilet accessories 6.00 18-Aug-15 24-Aug-15 11-Oct-15 18-Oct-15 -6.00 0% 0% 0.00
DHMEP34200 Pre-Testing & Commissioning 7.00 25-Aug-15 01-Sep-15 19-Oct-15 26-Oct-15 -6.00 0% 0% 0.00
LEVEL 35 368.00 04-Sep-14 28-Sep-15 04-Sep-14 A 19-Nov-15 -6.00 36.42% 36.42% 1.00
STRUCTURAL WORKS - LEVEL 35 21.00 04-Sep-14 23-Sep-14 04-Sep-14 A 27-Sep-14 A 100% 100% 1.00
DHCWA36100 Core Wall - L35 4.00 04-Sep-14 08-Sep-14 04-Sep-14 A 14-Sep-14 A 100% 100% 1.00
DHSLA35100 Construction of Horizontals - L35 4.00 17-Sep-14 21-Sep-14 22-Sep-14 A 24-Sep-14 A 100% 100% 1.00
DHCWA36110 Construction of Verticals - L35 2.00 22-Sep-14 23-Sep-14 25-Sep-14 A 27-Sep-14 A 100% 100% 1.00
STAIRCASES 4.00 22-Nov-14 25-Nov-14 26-Nov-14 30-Nov-14 41.00 0% 0% 0.00
A1880 Stair # 1 4.00 22-Nov-14 25-Nov-14 26-Nov-14 30-Nov-14 8.00 0% 0% 0.00
A1890 Stair # 2 4.00 22-Nov-14 25-Nov-14 26-Nov-14 30-Nov-14 41.00 0% 0% 0.00
FINISHES WORKS - LEVEL 35 333.00 14-Oct-14 28-Sep-15 18-Oct-14 19-Nov-15 -6.00 0% 0% 0.00
Dry area 292.00 12-Nov-14 12-Sep-15 22-Nov-14 05-Nov-15 -6.00 0% 0% 0.00
DHFSH35100 Block Work in Dry Area 6.00 12-Nov-14 18-Nov-14 22-Nov-14 27-Nov-14 -5.00 0% 0% 0.00
DHFSH35120 Marking,Cutting & Chasing - Dry Area 4.00 19-Nov-14 23-Nov-14 29-Nov-14 03-Dec-14 41.00 0% 0% 0.00
DHFSH35130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 24-Nov-14 27-Nov-14 04-Dec-14 08-Dec-14 43.00 0% 0% 0.00
DHFSH35160 Plaster in Dry Area 8.00 01-Dec-14 10-Dec-14 11-Dec-14 20-Dec-14 41.00 0% 0% 0.00
DHMEP35190 Dry Area Floor Screed 7.00 11-Dec-14 18-Dec-14 21-Dec-14 28-Dec-14 41.00 0% 0% 0.00
DHFSH35230 Dry Area Painting - Primer 4.00 20-Dec-14 23-Dec-14 29-Dec-14 03-Jan-15 108.00 0% 0% 0.00
DHFSH35260 Dry Area Painting - Stucco 6.00 24-Dec-14 30-Dec-14 04-Jan-15 10-Jan-15 108.00 0% 0% 0.00
DHFSH35290 Dry Area False Ceiling Suspension 6.00 11-Jan-15 18-Jan-15 09-Mar-15 16-Mar-15 -23.00 0% 0% 0.00
DHFSH35350 Dry Area False Ceiling Tiling / Boarding 5.00 14-Mar-15 18-Mar-15 01-Apr-15 07-Apr-15 34.00 0% 0% 0.00
DHFSH35400 Dry Area Painting - 1st Coat 5.00 30-Mar-15 04-Apr-15 01-Jul-15 06-Jul-15 -38.00 0% 0% 0.00
DHFSH35450 Dry Area Flooring 5.00 14-Apr-15 19-Apr-15 13-Jul-15 20-Jul-15 -43.00 0% 0% 0.00
DHFSH35430 Installation of Timber Doors & Ironmongery 5.00 09-Aug-15 13-Aug-15 25-Aug-15 31-Aug-15 -14.00 0% 0% 0.00
DHFSH35802 Installation of Wardrobe 12.00 10-Aug-15 23-Aug-15 26-Aug-15 09-Sep-15 -14.00 0% 0% 0.00
DHFSH35500 Paint Final Coat 6.00 06-Sep-15 12-Sep-15 31-Oct-15 05-Nov-15 -6.00 0% 0% 0.00
Wet area 270.00 12-Nov-14 19-Aug-15 22-Nov-14 10-Oct-15 -35.00 0% 0% 0.00
DHFSH35110 Block Work in Wet Area 6.00 12-Nov-14 18-Nov-14 22-Nov-14 27-Nov-14 41.00 0% 0% 0.00
DHFSH35140 Marking,Cutting & Chasing - Wet Area 4.00 19-Nov-14 23-Nov-14 29-Nov-14 03-Dec-14 41.00 0% 0% 0.00
DHFSH35150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 24-Nov-14 27-Nov-14 04-Dec-14 08-Dec-14 50.00 0% 0% 0.00
DHMEP35170 Plaster in Wet Area 4.00 01-Dec-14 06-Dec-14 11-Dec-14 15-Dec-14 48.00 0% 0% 0.00
DHMEP35180 Wet Area Wall Tiling 6.00 06-Jan-15 13-Jan-15 10-Feb-15 16-Feb-15 1.00 0% 0% 0.00
DHFSH35300 Wet Area False Ceiling Suspension 5.00 18-Jan-15 24-Jan-15 16-Mar-15 22-Mar-15 -19.00 0% 0% 0.00
DHFSH35370 Wet Area False Ceiling Tiling/Boarding 4.00 14-Mar-15 17-Mar-15 01-Apr-15 06-Apr-15 3.00 0% 0% 0.00
DHFSH35210 Wet Area Waterproofing 4.00 18-Mar-15 22-Mar-15 06-Apr-15 11-Apr-15 3.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - L35
Construction of Horizontals - L35
Construction of Verticals - L35
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 48 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH35220 Wet Area Floor Screed 4.00 23-Mar-15 26-Mar-15 11-Apr-15 15-Apr-15 3.00 0% 0% 0.00
DHFSH35250 Wet Area Floor Tiling 5.00 28-Mar-15 01-Apr-15 15-Apr-15 21-Apr-15 3.00 0% 0% 0.00
DHFSH06770 Cabinet Carcass 4.00 07-Apr-15 11-Apr-15 26-Apr-15 29-Apr-15 -1.00 0% 0% 0.00
DHFSH35800 Installation of Kitchen Cabinet 12.00 04-Aug-15 17-Aug-15 20-Aug-15 03-Sep-15 -14.00 0% 0% 0.00
DHFSH35390 Installation of Vanity Counters & Tops 5.00 15-Aug-15 19-Aug-15 31-Aug-15 06-Sep-15 -7.00 0% 0% 0.00
DHFSH35420 Installation of Shower Enclosure 4.00 13-Aug-15 17-Aug-15 06-Oct-15 10-Oct-15 -38.00 0% 0% 0.00
Lift Lobby / Corridor 183.00 20-Dec-14 21-Jun-15 29-Dec-14 03-Aug-15 62.00 0% 0% 0.00
DHFSH35240 Corridor/Lift Lobby Floor Screed 4.00 20-Dec-14 23-Dec-14 29-Dec-14 03-Jan-15 41.00 0% 0% 0.00
DHFSH35270 Lift Lobby Painting - Primer & Stucco 6.00 24-Dec-14 30-Dec-14 04-Jan-15 10-Jan-15 41.00 0% 0% 0.00
DHFSH35310 Lift Lobby False Ceiling Suspension 6.00 24-Jan-15 31-Jan-15 22-Mar-15 29-Mar-15 -19.00 0% 0% 0.00
DHFSH35360 Lift Lobby False Ceiling Tiling / Boarding 5.00 14-Mar-15 18-Mar-15 01-Apr-15 07-Apr-15 78.00 0% 0% 0.00
DHFSH35410 Lift Lobby Painting - 1st Coat 6.00 19-Mar-15 25-Mar-15 21-Jun-15 27-Jun-15 15.00 0% 0% 0.00
DHFSH35440 Installation of Steel Doors & Windows 3.00 18-Jun-15 21-Jun-15 11-Jul-15 13-Jul-15 -19.00 0% 0% 0.00
DHFSH35470 Lift Lobby Flooring 6.00 20-Apr-15 26-Apr-15 21-Jul-15 27-Jul-15 62.00 0% 0% 0.00
DHFSH35490 Utility Rooms- Epoxy Flooring 6.00 27-Apr-15 03-May-15 28-Jul-15 03-Aug-15 62.00 0% 0% 0.00
Staircase 181.00 11-Dec-14 29-Jun-15 21-Dec-14 23-Jul-15 13.00 0% 0% 0.00
DHFSH35200 Staircase Plastering 4.00 11-Dec-14 15-Dec-14 21-Dec-14 24-Dec-14 143.00 0% 0% 0.00
DHFSH35280 Staircase Painting - Primer & Stucco 6.00 31-Dec-14 07-Jan-15 11-Jan-15 17-Jan-15 130.00 0% 0% 0.00
DHFSH35320 Staircase Handrail Fixing 3.00 17-Mar-15 21-Mar-15 28-Jan-15 31-Jan-15 140.00 0% 0% 0.00
DHFSH35330 Staircase Painting 1st Coat 3.00 08-Apr-15 11-Apr-15 11-Jul-15 13-Jul-15 4.00 0% 0% 0.00
DHFSH35340 Staircase Final Painting 5.00 22-Jun-15 27-Jun-15 14-Jul-15 21-Jul-15 13.00 0% 0% 0.00
DHFSH35380 Staircase Epoxy Flooring 2.00 28-Jun-15 29-Jun-15 22-Jul-15 23-Jul-15 13.00 0% 0% 0.00
General 333.00 14-Oct-14 28-Sep-15 18-Oct-14 19-Nov-15 -6.00 0% 0% 0.00
DHSTR35000 Access from Structure 0.00 14-Oct-14 18-Oct-14 3.00 0% 0% 0.00
DHFSH35510 Snagging & De-Snagging 12.00 13-Sep-15 28-Sep-15 07-Nov-15 19-Nov-15 -6.00 0% 0% 0.00
MEP - LEVEL 35 333.00 18-Sep-14 05-Sep-15 23-Sep-14 A 29-Oct-15 -6.00 0% 0% 0.00
DHMEP35000 Embeded Conduits & Boxex - Concrete Works 3.00 18-Sep-14 21-Sep-14 23-Sep-14 A 24-Sep-14 A 100% 100% 0.00
DHMEP35100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C21a-bOlicntg-1 ,4 Wiring et1c1-Nov-14 28-Oct-14 17-Nov-14 -5.00 0% 0% 0.00
DHMEP35130 Cable Trays & Cable Trunking 6.00 19-Nov-14 25-Nov-14 29-Nov-14 06-Dec-14 55.00 0% 0% 0.00
DHMEP35120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 24-Nov-14 30-Nov-14 04-Dec-14 10-Dec-14 41.00 0% 0% 0.00
DHMEP35160 Pressure Testing of Pipes 12.00 01-Dec-14 15-Dec-14 11-Dec-14 24-Dec-14 68.00 0% 0% 0.00
DHMEP35110 MEP Works in Risers& Clearance 5.00 15-Jan-15 20-Jan-15 23-Feb-15 28-Feb-15 -33.00 0% 0% 0.00
DHMEP35140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es07-Mar-15 12-Mar-15 25-Mar-15 01-Apr-15 -10.00 0% 0% 0.00
DHMEP35150 MEP Final Fixes 6.00 18-Aug-15 24-Aug-15 11-Oct-15 18-Oct-15 -9.00 0% 0% 0.00
DHMEP06470 Sanitary ware /Toilet accessories 6.00 22-Aug-15 27-Aug-15 15-Oct-15 21-Oct-15 -6.00 0% 0% 0.00
DHMEP35200 Pre-Testing & Commissioning 7.00 29-Aug-15 05-Sep-15 22-Oct-15 29-Oct-15 -6.00 0% 0% 0.00
LEVEL 36 401.00 09-Sep-14 05-Oct-15 15-Sep-14 A 03-Jan-16 -40.00 36.45% 31.42% 0.86
STRUCTURAL WORKS - LEVEL 36 21.00 09-Sep-14 29-Sep-14 15-Sep-14 A 01-Oct-14 -1.00 100% 86.19% 0.86
DHCWA37100 Core Wall - L36 7.00 09-Sep-14 16-Sep-14 15-Sep-14 A 17-Sep-14 A 100% 100% 1.00
DHSLA36100 Construction of Horizontals - L36 4.00 23-Sep-14 27-Sep-14 28-Sep-14 A 30-Sep-14 A 100% 100% 1.00
DHCWA37110 Construction of Verticals - L36 2.00 28-Sep-14 29-Sep-14 30-Sep-14 A 01-Oct-14 -1.00 100% 50% 0.50
STAIRCASES 4.00 26-Nov-14 30-Nov-14 01-Dec-14 06-Dec-14 41.00 0% 0% 0.00
A1900 Stair # 1 4.00 26-Nov-14 30-Nov-14 01-Dec-14 06-Dec-14 8.00 0% 0% 0.00
A1910 Stair # 2 4.00 26-Nov-14 30-Nov-14 01-Dec-14 06-Dec-14 41.00 0% 0% 0.00
FINISHES WORKS - LEVEL 36 335.00 19-Oct-14 05-Oct-15 22-Oct-14 26-Nov-15 -9.00 0% 0% 0.00
Dry area 294.00 18-Nov-14 19-Sep-15 26-Nov-14 12-Nov-15 -9.00 0% 0% 0.00
DHFSH36100 Block Work in Dry Area 6.00 18-Nov-14 24-Nov-14 26-Nov-14 03-Dec-14 -5.00 0% 0% 0.00
DHFSH36120 Marking,Cutting & Chasing - Dry Area 4.00 25-Nov-14 29-Nov-14 04-Dec-14 08-Dec-14 40.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Kitchen Cabinet
Installation of Vanity Counters & Tops
Installation of Shower Enclosure
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - L36
Construction of Horizontals - L36
Construction of Verticals - L36
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 49 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH36130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 30-Nov-14 04-Dec-14 09-Dec-14 13-Dec-14 42.00 0% 0% 0.00
DHFSH36160 Plaster in Dry Area 8.00 08-Dec-14 16-Dec-14 16-Dec-14 24-Dec-14 40.00 0% 0% 0.00
DHMEP36190 Dry Area Floor Screed 7.00 17-Dec-14 24-Dec-14 25-Dec-14 03-Jan-15 40.00 0% 0% 0.00
DHFSH36230 Dry Area Painting - Primer 4.00 25-Dec-14 29-Dec-14 04-Jan-15 07-Jan-15 108.00 0% 0% 0.00
DHFSH36260 Dry Area Painting - Stucco 6.00 30-Dec-14 06-Jan-15 08-Jan-15 14-Jan-15 108.00 0% 0% 0.00
DHFSH36290 Dry Area False Ceiling Suspension 6.00 15-Jan-15 22-Jan-15 14-Mar-15 21-Mar-15 -23.00 0% 0% 0.00
DHFSH36350 Dry Area False Ceiling Tiling / Boarding 5.00 17-Mar-15 22-Mar-15 06-Apr-15 12-Apr-15 34.00 0% 0% 0.00
DHFSH36400 Dry Area Painting - 1st Coat 5.00 02-Apr-15 07-Apr-15 05-Jul-15 09-Jul-15 -37.00 0% 0% 0.00
DHFSH36450 Dry Area Flooring 5.00 19-Apr-15 23-Apr-15 20-Jul-15 25-Jul-15 -43.00 0% 0% 0.00
DHFSH36430 Installation of Timber Doors & Ironmongery 5.00 12-Aug-15 17-Aug-15 29-Aug-15 03-Sep-15 -14.00 0% 0% 0.00
DHFSH36802 Installation of Wardrobe 12.00 15-Aug-15 27-Aug-15 31-Aug-15 14-Sep-15 -14.00 0% 0% 0.00
DHFSH36500 Paint Final Coat 6.00 13-Sep-15 19-Sep-15 07-Nov-15 12-Nov-15 -9.00 0% 0% 0.00
Wet area 269.00 18-Nov-14 23-Aug-15 26-Nov-14 14-Oct-15 -35.00 0% 0% 0.00
DHFSH36110 Block Work in Wet Area 6.00 18-Nov-14 24-Nov-14 26-Nov-14 03-Dec-14 40.00 0% 0% 0.00
DHFSH36140 Marking,Cutting & Chasing - Wet Area 4.00 25-Nov-14 29-Nov-14 04-Dec-14 08-Dec-14 40.00 0% 0% 0.00
DHFSH36150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 30-Nov-14 04-Dec-14 09-Dec-14 13-Dec-14 50.00 0% 0% 0.00
DHMEP36170 Plaster in Wet Area 4.00 08-Dec-14 11-Dec-14 16-Dec-14 20-Dec-14 48.00 0% 0% 0.00
DHMEP36180 Wet Area Wall Tiling 6.00 11-Jan-15 18-Jan-15 15-Feb-15 21-Feb-15 1.00 0% 0% 0.00
DHFSH36300 Wet Area False Ceiling Suspension 5.00 22-Jan-15 28-Jan-15 21-Mar-15 26-Mar-15 -20.00 0% 0% 0.00
DHFSH36370 Wet Area False Ceiling Tiling/Boarding 4.00 17-Mar-15 21-Mar-15 06-Apr-15 11-Apr-15 3.00 0% 0% 0.00
DHFSH36210 Wet Area Waterproofing 4.00 22-Mar-15 25-Mar-15 11-Apr-15 15-Apr-15 3.00 0% 0% 0.00
DHFSH36220 Wet Area Floor Screed 4.00 26-Mar-15 30-Mar-15 15-Apr-15 20-Apr-15 3.00 0% 0% 0.00
DHFSH36250 Wet Area Floor Tiling 5.00 31-Mar-15 05-Apr-15 20-Apr-15 26-Apr-15 3.00 0% 0% 0.00
DHFSH06780 Cabinet Carcass 4.00 12-Apr-15 15-Apr-15 30-Apr-15 04-May-15 -1.00 0% 0% 0.00
DHFSH36800 Installation of Kitchen Cabinet 12.00 08-Aug-15 20-Aug-15 24-Aug-15 07-Sep-15 -14.00 0% 0% 0.00
DHFSH36390 Installation of Vanity Counters & Tops 5.00 18-Aug-15 23-Aug-15 03-Sep-15 09-Sep-15 -7.00 0% 0% 0.00
DHFSH36420 Installation of Shower Enclosure 4.00 17-Aug-15 20-Aug-15 10-Oct-15 14-Oct-15 -38.00 0% 0% 0.00
Lift Lobby / Corridor 183.00 25-Dec-14 24-Jun-15 04-Jan-15 08-Aug-15 60.00 0% 0% 0.00
DHFSH36240 Corridor/Lift Lobby Floor Screed 4.00 25-Dec-14 29-Dec-14 04-Jan-15 07-Jan-15 40.00 0% 0% 0.00
DHFSH36270 Lift Lobby Painting - Primer & Stucco 6.00 30-Dec-14 06-Jan-15 08-Jan-15 14-Jan-15 40.00 0% 0% 0.00
DHFSH36310 Lift Lobby False Ceiling Suspension 6.00 28-Jan-15 04-Feb-15 26-Mar-15 02-Apr-15 -20.00 0% 0% 0.00
DHFSH36360 Lift Lobby False Ceiling Tiling / Boarding 5.00 17-Mar-15 22-Mar-15 06-Apr-15 12-Apr-15 77.00 0% 0% 0.00
DHFSH36410 Lift Lobby Painting - 1st Coat 6.00 23-Mar-15 29-Mar-15 24-Jun-15 30-Jun-15 15.00 0% 0% 0.00
DHFSH36440 Installation of Steel Doors & Windows 3.00 22-Jun-15 24-Jun-15 14-Jul-15 16-Jul-15 -19.00 0% 0% 0.00
DHFSH36470 Lift Lobby Flooring 6.00 25-Apr-15 30-Apr-15 26-Jul-15 01-Aug-15 60.00 0% 0% 0.00
DHFSH36490 Utility Rooms- Epoxy Flooring 6.00 02-May-15 07-May-15 02-Aug-15 08-Aug-15 60.00 0% 0% 0.00
Staircase 180.00 17-Dec-14 02-Jul-15 25-Dec-14 27-Jul-15 13.00 0% 0% 0.00
DHFSH36200 Staircase Plastering 4.00 17-Dec-14 21-Dec-14 25-Dec-14 29-Dec-14 142.00 0% 0% 0.00
DHFSH36280 Staircase Painting - Primer & Stucco 6.00 07-Jan-15 13-Jan-15 15-Jan-15 21-Jan-15 129.00 0% 0% 0.00
DHFSH36320 Staircase Handrail Fixing 3.00 21-Mar-15 24-Mar-15 01-Feb-15 03-Feb-15 140.00 0% 0% 0.00
DHFSH36330 Staircase Painting 1st Coat 3.00 12-Apr-15 14-Apr-15 14-Jul-15 16-Jul-15 4.00 0% 0% 0.00
DHFSH36340 Staircase Final Painting 5.00 25-Jun-15 30-Jun-15 20-Jul-15 25-Jul-15 13.00 0% 0% 0.00
DHFSH36380 Staircase Epoxy Flooring 2.00 01-Jul-15 02-Jul-15 26-Jul-15 27-Jul-15 13.00 0% 0% 0.00
General 335.00 19-Oct-14 05-Oct-15 22-Oct-14 26-Nov-15 -9.00 0% 0% 0.00
DHSTR36000 Access from Structure 0.00 19-Oct-14 22-Oct-14 4.00 0% 0% 0.00
DHFSH36510 Snagging & De-Snagging 12.00 20-Sep-15 05-Oct-15 14-Nov-15 26-Nov-15 -9.00 0% 0% 0.00
MEP - LEVEL 36 379.00 24-Sep-14 12-Sep-15 28-Sep-14 A 03-Jan-16 -58.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Kitchen Cabinet
Installation of Vanity Counters & Tops
Installation of Shower Enclosure
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 50 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHMEP36000 Embeded Conduits & Boxex - Concrete Works 3.00 24-Sep-14 27-Sep-14 28-Sep-14 A 30-Sep-14 A 100% 100% 0.00
DHMEP36100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C28a-bOlicntg-1 ,4 Wiring et1c7-Nov-14 03-Nov-14 23-Nov-14 -5.00 0% 0% 0.00
DHMEP36130 Cable Trays & Cable Trunking 6.00 25-Nov-14 01-Dec-14 04-Dec-14 10-Dec-14 55.00 0% 0% 0.00
DHMEP36120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 30-Nov-14 07-Dec-14 09-Dec-14 15-Dec-14 40.00 0% 0% 0.00
DHMEP36160 Pressure Testing of Pipes 12.00 08-Dec-14 21-Dec-14 16-Dec-14 29-Dec-14 67.00 0% 0% 0.00
DHMEP36110 MEP Works in Risers& Clearance 5.00 21-Jan-15 26-Jan-15 01-Mar-15 05-Mar-15 -33.00 0% 0% 0.00
DHMEP36140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es10-Mar-15 16-Mar-15 30-Mar-15 06-Apr-15 -11.00 0% 0% 0.00
DHMEP36150 MEP Final Fixes 6.00 25-Aug-15 31-Aug-15 19-Oct-15 25-Oct-15 -9.00 0% 0% 0.00
DHMEP06550 Sanitary ware /Toilet accessories 6.00 29-Aug-15 03-Sep-15 22-Oct-15 28-Oct-15 -9.00 0% 0% 0.00
DHMEP36200 Pre-Testing & Commissioning 7.00 05-Sep-15 12-Sep-15 29-Oct-15 05-Nov-15 -9.00 0% 0% 0.00
DHMEP36010 Busbar - L36 to L40 10.00 28-Jun-15 08-Jul-15 23-Dec-15 03-Jan-16 -144.00 0% 0% 0.00
LEVEL 37 361.00 17-Sep-14 08-Oct-15 18-Sep-14 A 30-Nov-15 -9.00 17.63% 8.87% 0.50
STRUCTURAL WORKS - LEVEL 37 14.00 17-Sep-14 07-Oct-14 18-Sep-14 A 11-Oct-14 -2.00 48.36% 24.34% 0.50
DHCWA38100 Core Wall - L37 5.00 17-Sep-14 22-Sep-14 18-Sep-14 A 25-Sep-14 A 100% 100% 1.00
DHCWA38120 Tower Crane Jump 1.00 17-Sep-14 17-Sep-14 01-Oct-14 01-Oct-14 -4.00 100% 0% 0.00
DHSLA37100 Construction of Horizontals - L37 4.00 29-Sep-14 02-Oct-14 02-Oct-14 08-Oct-14 -2.00 50% 0% 0.00
DHCWA38110 Construction of Verticals - L37 2.00 06-Oct-14 07-Oct-14 09-Oct-14 11-Oct-14 -2.00 0% 0% 0.00
STAIRCASES 4.00 01-Dec-14 06-Dec-14 07-Dec-14 10-Dec-14 41.00 0% 0% 0.00
A1920 Stair # 1 4.00 01-Dec-14 06-Dec-14 07-Dec-14 10-Dec-14 8.00 0% 0% 0.00
A1930 Stair # 2 4.00 01-Dec-14 06-Dec-14 07-Dec-14 10-Dec-14 41.00 0% 0% 0.00
FINISHES WORKS - LEVEL 37 333.00 26-Oct-14 08-Oct-15 29-Oct-14 30-Nov-15 -9.00 0% 0% 0.00
Dry area 293.00 24-Nov-14 22-Sep-15 01-Dec-14 16-Nov-15 -9.00 0% 0% 0.00
DHFSH37100 Block Work in Dry Area 6.00 24-Nov-14 30-Nov-14 01-Dec-14 08-Dec-14 -5.00 0% 0% 0.00
DHFSH37120 Marking,Cutting & Chasing - Dry Area 4.00 01-Dec-14 06-Dec-14 09-Dec-14 13-Dec-14 39.00 0% 0% 0.00
DHFSH37130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 07-Dec-14 10-Dec-14 14-Dec-14 17-Dec-14 41.00 0% 0% 0.00
DHFSH37160 Plaster in Dry Area 8.00 14-Dec-14 22-Dec-14 21-Dec-14 29-Dec-14 39.00 0% 0% 0.00
DHMEP37190 Dry Area Floor Screed 7.00 23-Dec-14 30-Dec-14 30-Dec-14 07-Jan-15 39.00 0% 0% 0.00
DHFSH37230 Dry Area Painting - Primer 4.00 31-Dec-14 05-Jan-15 08-Jan-15 12-Jan-15 108.00 0% 0% 0.00
DHFSH37260 Dry Area Painting - Stucco 6.00 06-Jan-15 12-Jan-15 13-Jan-15 19-Jan-15 108.00 0% 0% 0.00
DHFSH37290 Dry Area False Ceiling Suspension 6.00 20-Jan-15 27-Jan-15 18-Mar-15 25-Mar-15 -23.00 0% 0% 0.00
DHFSH37350 Dry Area False Ceiling Tiling / Boarding 5.00 21-Mar-15 25-Mar-15 11-Apr-15 16-Apr-15 34.00 0% 0% 0.00
DHFSH37400 Dry Area Painting - 1st Coat 5.00 06-Apr-15 11-Apr-15 08-Jul-15 13-Jul-15 -36.00 0% 0% 0.00
DHFSH37450 Dry Area Flooring 5.00 23-Apr-15 28-Apr-15 25-Jul-15 29-Jul-15 -43.00 0% 0% 0.00
DHFSH37430 Installation of Timber Doors & Ironmongery 5.00 18-Aug-15 23-Aug-15 03-Sep-15 09-Sep-15 -14.00 0% 0% 0.00
DHFSH37802 Installation of Wardrobe 12.00 22-Aug-15 03-Sep-15 07-Sep-15 21-Sep-15 -14.00 0% 0% 0.00
DHFSH37500 Paint Final Coat 6.00 16-Sep-15 22-Sep-15 10-Nov-15 16-Nov-15 -9.00 0% 0% 0.00
Wet area 268.00 24-Nov-14 29-Aug-15 01-Dec-14 18-Oct-15 -35.00 0% 0% 0.00
DHFSH37110 Block Work in Wet Area 6.00 24-Nov-14 30-Nov-14 01-Dec-14 08-Dec-14 39.00 0% 0% 0.00
DHFSH37140 Marking,Cutting & Chasing - Wet Area 4.00 01-Dec-14 06-Dec-14 09-Dec-14 13-Dec-14 39.00 0% 0% 0.00
DHFSH37150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 07-Dec-14 10-Dec-14 14-Dec-14 17-Dec-14 50.00 0% 0% 0.00
DHMEP37170 Plaster in Wet Area 4.00 14-Dec-14 17-Dec-14 21-Dec-14 24-Dec-14 48.00 0% 0% 0.00
DHMEP37180 Wet Area Wall Tiling 6.00 15-Jan-15 22-Jan-15 19-Feb-15 25-Feb-15 1.00 0% 0% 0.00
DHFSH37300 Wet Area False Ceiling Suspension 5.00 27-Jan-15 02-Feb-15 25-Mar-15 31-Mar-15 -21.00 0% 0% 0.00
DHFSH37370 Wet Area False Ceiling Tiling/Boarding 4.00 21-Mar-15 24-Mar-15 11-Apr-15 15-Apr-15 3.00 0% 0% 0.00
DHMEP37210 Wet Area Waterproofing 4.00 25-Mar-15 29-Mar-15 15-Apr-15 20-Apr-15 3.00 0% 0% 0.00
DHFSH37220 Wet Area Floor Screed 4.00 30-Mar-15 02-Apr-15 20-Apr-15 25-Apr-15 3.00 0% 0% 0.00
DHFSH37250 Wet Area Floor Tiling 5.00 04-Apr-15 08-Apr-15 25-Apr-15 30-Apr-15 3.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - L37
Tower Crane Jump
Construction of Horizontals - L37
Construction of Verticals - L37
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 51 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHFSH06790 Cabinet Carcass 4.00 16-Apr-15 20-Apr-15 05-May-15 09-May-15 -1.00 0% 0% 0.00
DHFSH37800 Installation of Kitchen Cabinet 12.00 15-Aug-15 27-Aug-15 31-Aug-15 14-Sep-15 -14.00 0% 0% 0.00
DHFSH37390 Installation of Vanity Counters & Tops 5.00 24-Aug-15 29-Aug-15 09-Sep-15 15-Sep-15 -9.00 0% 0% 0.00
DHFSH37420 Installation of Shower Enclosure 4.00 23-Aug-15 26-Aug-15 14-Oct-15 18-Oct-15 -38.00 0% 0% 0.00
Lift Lobby / Corridor 181.00 31-Dec-14 28-Jun-15 08-Jan-15 10-Aug-15 60.00 0% 0% 0.00
DHFSH37240 Corridor/Lift Lobby Floor Screed 4.00 31-Dec-14 05-Jan-15 08-Jan-15 12-Jan-15 39.00 0% 0% 0.00
DHFSH37270 Lift Lobby Painting - Primer & Stucco 6.00 06-Jan-15 12-Jan-15 13-Jan-15 19-Jan-15 39.00 0% 0% 0.00
DHFSH37310 Lift Lobby False Ceiling Suspension 6.00 02-Feb-15 09-Feb-15 31-Mar-15 07-Apr-15 -21.00 0% 0% 0.00
DHFSH37360 Lift Lobby False Ceiling Tiling / Boarding 5.00 21-Mar-15 25-Mar-15 11-Apr-15 16-Apr-15 76.00 0% 0% 0.00
DHFSH37410 Lift Lobby Painting - 1st Coat 6.00 26-Mar-15 01-Apr-15 28-Jun-15 04-Jul-15 15.00 0% 0% 0.00
DHFSH37440 Installation of Steel Doors & Windows 3.00 25-Jun-15 28-Jun-15 20-Jul-15 22-Jul-15 -19.00 0% 0% 0.00
DHFSH37470 Lift Lobby Flooring 6.00 29-Apr-15 05-May-15 30-Jul-15 05-Aug-15 61.00 0% 0% 0.00
DHFSH37490 Utility Rooms- Epoxy Flooring 6.00 04-May-15 10-May-15 04-Aug-15 10-Aug-15 60.00 0% 0% 0.00
Staircase 180.00 23-Dec-14 06-Jul-15 30-Dec-14 01-Aug-15 14.00 0% 0% 0.00
DHFSH37200 Staircase Plastering 4.00 23-Dec-14 27-Dec-14 30-Dec-14 04-Jan-15 141.00 0% 0% 0.00
DHFSH37280 Staircase Painting - Primer & Stucco 6.00 13-Jan-15 19-Jan-15 20-Jan-15 26-Jan-15 128.00 0% 0% 0.00
DHFSH37320 Staircase Handrail Fixing 3.00 24-Mar-15 28-Mar-15 04-Feb-15 07-Feb-15 140.00 0% 0% 0.00
DHFSH37330 Staircase Painting 1st Coat 3.00 15-Apr-15 18-Apr-15 20-Jul-15 22-Jul-15 4.00 0% 0% 0.00
DHFSH37340 Staircase Final Painting 5.00 29-Jun-15 04-Jul-15 23-Jul-15 28-Jul-15 15.00 0% 0% 0.00
DHFSH37380 Staircase Epoxy Flooring 2.00 05-Jul-15 06-Jul-15 30-Jul-15 01-Aug-15 14.00 0% 0% 0.00
General 333.00 26-Oct-14 08-Oct-15 29-Oct-14 30-Nov-15 -9.00 0% 0% 0.00
DHSTR37000 Access from Structure 0.00 26-Oct-14 29-Oct-14 4.00 0% 0% 0.00
DHFSH37510 Snagging & De-Snagging 12.00 26-Sep-15 08-Oct-15 17-Nov-15 30-Nov-15 -9.00 0% 0% 0.00
MEP - LEVEL 37 334.00 30-Sep-14 15-Sep-15 06-Oct-14 09-Nov-15 -9.00 0% 0% 0.00
DHMEP37000 Embeded Conduits & Boxex - Concrete Works 3.00 30-Sep-14 02-Oct-14 06-Oct-14 08-Oct-14 20.00 33.33% 0% 0.00
DHMEP37100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C03a-bNlionvg- 1, 4Wiring et2c3-Nov-14 09-Nov-14 29-Nov-14 -5.00 0% 0% 0.00
DHMEP37130 Cable Trays & Cable Trunking 6.00 01-Dec-14 08-Dec-14 09-Dec-14 15-Dec-14 55.00 0% 0% 0.00
DHMEP37120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 07-Dec-14 13-Dec-14 14-Dec-14 20-Dec-14 39.00 0% 0% 0.00
DHMEP37160 Pressure Testing of Pipes 12.00 14-Dec-14 27-Dec-14 21-Dec-14 04-Jan-15 66.00 0% 0% 0.00
DHMEP37110 MEP Works in Risers& Clearance 5.00 27-Jan-15 01-Feb-15 07-Mar-15 11-Mar-15 -33.00 0% 0% 0.00
DHMEP37140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es14-Mar-15 19-Mar-15 04-Apr-15 11-Apr-15 -12.00 0% 0% 0.00
DHMEP37150 MEP Final Fixes 6.00 29-Aug-15 03-Sep-15 22-Oct-15 28-Oct-15 -9.00 0% 0% 0.00
DHMEP06580 Sanitary ware /Toilet accessories 6.00 01-Sep-15 07-Sep-15 26-Oct-15 01-Nov-15 -9.00 0% 0% 0.00
DHMEP37200 Pre-Testing & Commissioning 7.00 08-Sep-15 15-Sep-15 02-Nov-15 09-Nov-15 -9.00 0% 0% 0.00
LEVEL 38 362.00 23-Sep-14 12-Oct-15 27-Sep-14 A 05-Dec-15 -9.00 8.88% 8.88% 1.00
STRUCTURAL WORKS - LEVEL 38 15.00 23-Sep-14 11-Oct-14 27-Sep-14 A 14-Oct-14 -2.00 24.38% 24.38% 1.00
DHCWA39100 Core Wall - L38 4.00 23-Sep-14 27-Sep-14 27-Sep-14 A 29-Sep-14 A 100% 100% 1.00
DHSLA38100 Construction of Horizontals - L38 3.00 06-Oct-14 08-Oct-14 09-Oct-14 12-Oct-14 -2.00 0% 0% 0.00
DHCWA39110 Construction of Verticals - L38 2.00 09-Oct-14 11-Oct-14 13-Oct-14 14-Oct-14 -2.00 0% 0% 0.00
STAIRCASES 4.00 07-Dec-14 10-Dec-14 11-Dec-14 15-Dec-14 41.00 0% 0% 0.00
A1940 Stair # 1 4.00 07-Dec-14 10-Dec-14 11-Dec-14 15-Dec-14 8.00 0% 0% 0.00
A1950 Stair # 2 4.00 07-Dec-14 10-Dec-14 11-Dec-14 15-Dec-14 41.00 0% 0% 0.00
FINISHES WORKS - LEVEL 38 331.00 30-Oct-14 12-Oct-15 04-Nov-14 05-Dec-15 -9.00 0% 0% 0.00
Dry area 290.00 01-Dec-14 28-Sep-15 09-Dec-14 19-Nov-15 -9.00 0% 0% 0.00
DHFSH38100 Block Work in Dry Area 6.00 01-Dec-14 08-Dec-14 09-Dec-14 15-Dec-14 -5.00 0% 0% 0.00
DHFSH38120 Marking,Cutting & Chasing - Dry Area 4.00 09-Dec-14 13-Dec-14 16-Dec-14 20-Dec-14 36.00 0% 0% 0.00
DHFSH38130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 14-Dec-14 17-Dec-14 21-Dec-14 24-Dec-14 38.00 0% 0% 0.00
DHFSH38160 Plaster in Dry Area 8.00 21-Dec-14 29-Dec-14 28-Dec-14 06-Jan-15 36.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Cabinet Carcass
Installation of Kitchen Cabinet
Installation of Vanity Counters & Tops
Installation of Shower Enclosure
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - L38
Construction of Horizontals - L38
Construction of Verticals - L38
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 52 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHMEP38190 Dry Area Floor Screed 7.00 30-Dec-14 07-Jan-15 07-Jan-15 14-Jan-15 36.00 0% 0% 0.00
DHFSH38230 Dry Area Painting - Primer 4.00 08-Jan-15 12-Jan-15 15-Jan-15 19-Jan-15 147.00 0% 0% 0.00
DHFSH38260 Dry Area Painting - Stucco 6.00 13-Jan-15 19-Jan-15 20-Jan-15 26-Jan-15 147.00 0% 0% 0.00
DHFSH38290 Dry Area False Ceiling Suspension 6.00 25-Jan-15 01-Feb-15 23-Mar-15 30-Mar-15 -23.00 0% 0% 0.00
DHFSH38350 Dry Area False Ceiling Tiling / Boarding 5.00 24-Mar-15 29-Mar-15 15-Apr-15 21-Apr-15 34.00 0% 0% 0.00
DHFSH38400 Dry Area Painting - 1st Coat 5.00 09-Apr-15 14-Apr-15 12-Jul-15 16-Jul-15 -35.00 0% 0% 0.00
DHFSH38450 Dry Area Flooring 5.00 28-Apr-15 03-May-15 29-Jul-15 03-Aug-15 -43.00 0% 0% 0.00
DHFSH38430 Installation of Timber Doors & Ironmongery 5.00 22-Aug-15 26-Aug-15 07-Sep-15 13-Sep-15 -14.00 0% 0% 0.00
DHFSH38802 Installation of Wardrobe 12.00 29-Aug-15 10-Sep-15 14-Sep-15 30-Sep-15 -14.00 0% 0% 0.00
DHFSH38500 Paint Final Coat 6.00 20-Sep-15 28-Sep-15 14-Nov-15 19-Nov-15 -9.00 0% 0% 0.00
Wet area 265.00 01-Dec-14 03-Sep-15 09-Dec-14 21-Oct-15 -35.00 0% 0% 0.00
DHFSH38110 Block Work in Wet Area 6.00 01-Dec-14 08-Dec-14 09-Dec-14 15-Dec-14 36.00 0% 0% 0.00
DHFSH38140 Marking,Cutting & Chasing - Wet Area 4.00 09-Dec-14 13-Dec-14 16-Dec-14 20-Dec-14 36.00 0% 0% 0.00
DHFSH38150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 14-Dec-14 17-Dec-14 21-Dec-14 24-Dec-14 48.00 0% 0% 0.00
DHMEP38170 Plaster in Wet Area 4.00 21-Dec-14 24-Dec-14 28-Dec-14 31-Dec-14 46.00 0% 0% 0.00
DHMEP38180 Wet Area Wall Tiling 6.00 20-Jan-15 27-Jan-15 24-Feb-15 02-Mar-15 1.00 0% 0% 0.00
DHFSH38300 Wet Area False Ceiling Suspension 5.00 01-Feb-15 07-Feb-15 30-Mar-15 05-Apr-15 -22.00 0% 0% 0.00
DHFSH38370 Wet Area False Ceiling Tiling/Boarding 4.00 24-Mar-15 28-Mar-15 15-Apr-15 20-Apr-15 3.00 0% 0% 0.00
DHMEP38210 Wet Area Waterproofing 4.00 29-Mar-15 01-Apr-15 20-Apr-15 25-Apr-15 3.00 0% 0% 0.00
DHFSH38220 Wet Area Floor Screed 4.00 02-Apr-15 06-Apr-15 25-Apr-15 29-Apr-15 3.00 0% 0% 0.00
DHFSH38250 Wet Area Floor Tiling 5.00 07-Apr-15 12-Apr-15 29-Apr-15 05-May-15 3.00 0% 0% 0.00
DHFSH06810 Cabinet Carcass 4.00 21-Apr-15 25-Apr-15 10-May-15 13-May-15 -1.00 0% 0% 0.00
DHFSH38390 Installation of Vanity Counters & Tops 5.00 27-Aug-15 01-Sep-15 13-Sep-15 19-Sep-15 -9.00 0% 0% 0.00
DHFSH38800 Installation of Kitchen Cabinet 12.00 22-Aug-15 03-Sep-15 07-Sep-15 21-Sep-15 -14.00 0% 0% 0.00
DHFSH38420 Installation of Shower Enclosure 4.00 26-Aug-15 30-Aug-15 18-Oct-15 21-Oct-15 -38.00 0% 0% 0.00
Lift Lobby / Corridor 181.00 08-Jan-15 01-Jul-15 15-Jan-15 17-Aug-15 56.00 0% 0% 0.00
DHFSH38240 Corridor/Lift Lobby Floor Screed 4.00 08-Jan-15 12-Jan-15 15-Jan-15 19-Jan-15 36.00 0% 0% 0.00
DHFSH38270 Lift Lobby Painting - Primer & Stucco 6.00 13-Jan-15 19-Jan-15 20-Jan-15 26-Jan-15 36.00 0% 0% 0.00
DHFSH38310 Lift Lobby False Ceiling Suspension 6.00 07-Feb-15 14-Feb-15 05-Apr-15 12-Apr-15 -22.00 0% 0% 0.00
DHFSH38360 Lift Lobby False Ceiling Tiling / Boarding 5.00 24-Mar-15 29-Mar-15 15-Apr-15 21-Apr-15 75.00 0% 0% 0.00
DHFSH38410 Lift Lobby Painting - 1st Coat 6.00 30-Mar-15 05-Apr-15 01-Jul-15 07-Jul-15 15.00 0% 0% 0.00
DHFSH38440 Installation of Steel Doors & Windows 3.00 29-Jun-15 01-Jul-15 23-Jul-15 26-Jul-15 -19.00 0% 0% 0.00
DHFSH38470 Lift Lobby Flooring 6.00 04-May-15 10-May-15 04-Aug-15 10-Aug-15 56.00 0% 0% 0.00
DHFSH38490 Utility Rooms- Epoxy Flooring 6.00 11-May-15 18-May-15 11-Aug-15 17-Aug-15 56.00 0% 0% 0.00
Staircase 178.00 30-Dec-14 09-Jul-15 07-Jan-15 05-Aug-15 13.00 0% 0% 0.00
DHFSH38200 Staircase Plastering 4.00 30-Dec-14 04-Jan-15 07-Jan-15 11-Jan-15 138.00 0% 0% 0.00
DHFSH38280 Staircase Painting - Primer & Stucco 6.00 20-Jan-15 26-Jan-15 27-Jan-15 02-Feb-15 125.00 0% 0% 0.00
DHFSH38320 Staircase Handrail Fixing 3.00 28-Mar-15 31-Mar-15 08-Feb-15 10-Feb-15 140.00 0% 0% 0.00
DHFSH38330 Staircase Painting 1st Coat 3.00 19-Apr-15 21-Apr-15 23-Jul-15 26-Jul-15 4.00 0% 0% 0.00
DHFSH38340 Staircase Final Painting 5.00 02-Jul-15 07-Jul-15 27-Jul-15 01-Aug-15 15.00 0% 0% 0.00
DHFSH38380 Staircase Epoxy Flooring 2.00 08-Jul-15 09-Jul-15 04-Aug-15 05-Aug-15 13.00 0% 0% 0.00
General 331.00 30-Oct-14 12-Oct-15 04-Nov-14 05-Dec-15 -9.00 0% 0% 0.00
DHSTR38000 Access from Structure 0.00 30-Oct-14 04-Nov-14 4.00 0% 0% 0.00
DHFSH38510 Snagging & De-Snagging 12.00 29-Sep-15 12-Oct-15 21-Nov-15 05-Dec-15 -9.00 0% 0% 0.00
MEP - LEVEL 38 333.00 07-Oct-14 19-Sep-15 11-Oct-14 12-Nov-15 -9.00 0% 0% 0.00
DHMEP38000 Embeded Conduits & Boxex - Concrete Works 3.00 07-Oct-14 09-Oct-14 11-Oct-14 13-Oct-14 21.00 0% 0% 0.00
DHMEP38100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C09a-bNlionvg- 1, 4Wiring et2c9-Nov-14 15-Nov-14 06-Dec-14 -5.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Installation of Shower Enclosure
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 53 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHMEP38130 Cable Trays & Cable Trunking 6.00 09-Dec-14 15-Dec-14 16-Dec-14 22-Dec-14 53.00 0% 0% 0.00
DHMEP38120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 14-Dec-14 20-Dec-14 21-Dec-14 27-Dec-14 36.00 0% 0% 0.00
DHMEP38160 Pressure Testing of Pipes 12.00 21-Dec-14 04-Jan-15 28-Dec-14 11-Jan-15 63.00 0% 0% 0.00
DHMEP38110 MEP Works in Risers& Clearance 5.00 02-Feb-15 07-Feb-15 12-Mar-15 17-Mar-15 -33.00 0% 0% 0.00
DHMEP38140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es17-Mar-15 23-Mar-15 08-Apr-15 15-Apr-15 -13.00 0% 0% 0.00
DHMEP38150 MEP Final Fixes 6.00 01-Sep-15 07-Sep-15 26-Oct-15 01-Nov-15 -9.00 0% 0% 0.00
DHMEP06560 Sanitary ware /Toilet accessories 6.00 05-Sep-15 10-Sep-15 29-Oct-15 04-Nov-15 -9.00 0% 0% 0.00
DHMEP38200 Pre-Testing & Commissioning 7.00 12-Sep-15 19-Sep-15 05-Nov-15 12-Nov-15 -9.00 0% 0% 0.00
LEVEL 39 361.00 28-Sep-14 17-Oct-15 30-Sep-14 A 08-Dec-15 -9.00 6.65% 0% 0.00
STRUCTURAL WORKS - LEVEL 39 15.00 28-Sep-14 15-Oct-14 30-Sep-14 A 19-Oct-14 -2.00 18.25% 0% 0.00
DHCWA40100 Core Wall - L39 4.00 28-Sep-14 01-Oct-14 30-Sep-14 A 08-Oct-14 -4.00 75% 0% 0.00
DHSLA39100 Construction of Horizontals - L39 4.00 09-Oct-14 13-Oct-14 13-Oct-14 16-Oct-14 -2.00 0% 0% 0.00
DHCWA40110 Construction of Verticals - L39 2.00 14-Oct-14 15-Oct-14 18-Oct-14 19-Oct-14 -2.00 0% 0% 0.00
STAIRCASES 4.00 11-Dec-14 15-Dec-14 16-Dec-14 20-Dec-14 41.00 0% 0% 0.00
A1960 Stair # 1 4.00 11-Dec-14 15-Dec-14 16-Dec-14 20-Dec-14 8.00 0% 0% 0.00
A1970 Stair # 2 4.00 11-Dec-14 15-Dec-14 16-Dec-14 20-Dec-14 41.00 0% 0% 0.00
FINISHES WORKS - LEVEL 39 329.00 05-Nov-14 17-Oct-15 10-Nov-14 08-Dec-15 -9.00 0% 0% 0.00
Dry area 289.00 07-Dec-14 01-Oct-15 14-Dec-14 23-Nov-15 -9.00 0% 0% 0.00
DHFSH39100 Block Work in Dry Area 6.00 07-Dec-14 13-Dec-14 14-Dec-14 20-Dec-14 -5.00 0% 0% 0.00
DHFSH39120 Marking,Cutting & Chasing - Dry Area 4.00 14-Dec-14 17-Dec-14 21-Dec-14 24-Dec-14 35.00 0% 0% 0.00
DHFSH39130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 18-Dec-14 22-Dec-14 25-Dec-14 29-Dec-14 37.00 0% 0% 0.00
DHFSH39160 Plaster in Dry Area 8.00 25-Dec-14 04-Jan-15 03-Jan-15 11-Jan-15 35.00 0% 0% 0.00
DHFSH39190 Dry Area Floor Screed 7.00 05-Jan-15 12-Jan-15 12-Jan-15 19-Jan-15 35.00 0% 0% 0.00
DHFSH39230 Dry Area Painting - Primer 4.00 13-Jan-15 17-Jan-15 20-Jan-15 24-Jan-15 106.00 0% 0% 0.00
DHFSH39260 Dry Area Painting - Stucco 6.00 18-Jan-15 24-Jan-15 25-Jan-15 31-Jan-15 106.00 0% 0% 0.00
DHFSH39290 Dry Area False Ceiling Suspension 6.00 29-Jan-15 05-Feb-15 28-Mar-15 04-Apr-15 -23.00 0% 0% 0.00
DHFSH39350 Dry Area False Ceiling Tiling / Boarding 5.00 28-Mar-15 01-Apr-15 20-Apr-15 26-Apr-15 34.00 0% 0% 0.00
DHFSH39400 Dry Area Painting - 1st Coat 5.00 13-Apr-15 18-Apr-15 15-Jul-15 22-Jul-15 -34.00 0% 0% 0.00
DHFSH39450 Dry Area Flooring 5.00 03-May-15 07-May-15 03-Aug-15 08-Aug-15 -43.00 0% 0% 0.00
DHFSH39430 Installation of Timber Doors & Ironmongery 5.00 25-Aug-15 30-Aug-15 10-Sep-15 16-Sep-15 -14.00 0% 0% 0.00
DHFSH39802 Installation of Wardrobe 12.00 02-Sep-15 15-Sep-15 19-Sep-15 05-Oct-15 -14.00 0% 0% 0.00
DHFSH39500 Paint Final Coat 6.00 26-Sep-15 01-Oct-15 17-Nov-15 23-Nov-15 -9.00 0% 0% 0.00
Wet area 264.00 07-Dec-14 07-Sep-15 14-Dec-14 25-Oct-15 -35.00 0% 0% 0.00
DHFSH39110 Block Work in Wet Area 6.00 07-Dec-14 13-Dec-14 14-Dec-14 20-Dec-14 35.00 0% 0% 0.00
DHFSH39140 Marking,Cutting & Chasing - Wet Area 4.00 14-Dec-14 17-Dec-14 21-Dec-14 24-Dec-14 35.00 0% 0% 0.00
DHFSH39150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 18-Dec-14 22-Dec-14 25-Dec-14 29-Dec-14 48.00 0% 0% 0.00
DHFSH39170 Plaster in Wet Area 4.00 25-Dec-14 29-Dec-14 03-Jan-15 06-Jan-15 46.00 0% 0% 0.00
DHFSH39180 Wet Area Wall Tiling 6.00 25-Jan-15 01-Feb-15 01-Mar-15 07-Mar-15 1.00 0% 0% 0.00
DHFSH39300 Wet Area False Ceiling Suspension 5.00 05-Feb-15 11-Feb-15 04-Apr-15 09-Apr-15 -23.00 0% 0% 0.00
DHFSH39370 Wet Area False Ceiling Tiling/Boarding 4.00 28-Mar-15 31-Mar-15 20-Apr-15 25-Apr-15 3.00 0% 0% 0.00
DHFSH39210 Wet Area Waterproofing 4.00 01-Apr-15 05-Apr-15 25-Apr-15 29-Apr-15 3.00 0% 0% 0.00
DHFSH39220 Wet Area Floor Screed 4.00 06-Apr-15 09-Apr-15 29-Apr-15 04-May-15 3.00 0% 0% 0.00
DHFSH39250 Wet Area Floor Tiling 5.00 11-Apr-15 15-Apr-15 04-May-15 10-May-15 3.00 0% 0% 0.00
DHFSH06820 Cabinet Carcass 4.00 26-Apr-15 29-Apr-15 14-May-15 19-May-15 -1.00 0% 0% 0.00
DHFSH39390 Installation of Vanity Counters & Tops 5.00 31-Aug-15 05-Sep-15 16-Sep-15 22-Sep-15 -9.00 0% 0% 0.00
DHFSH39800 Installation of Kitchen Cabinet 12.00 25-Aug-15 07-Sep-15 10-Sep-15 27-Sep-15 -14.00 0% 0% 0.00
DHFSH39420 Installation of Shower Enclosure 4.00 30-Aug-15 02-Sep-15 21-Oct-15 25-Oct-15 -38.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
Core Wall - L39
Construction of Horizontals - L39
Construction of Verticals - L39
Stair # 1
Stair # 2
Block Work in Dry Area
Marking,Cutting & Chasing - Dry Area
Sub frame Fixing/Plaster Preparation - Dry Area
Plaster in Dry Area
Dry Area Floor Screed
Dry Area Painting - Primer
Dry Area Painting - Stucco
Dry Area False Ceiling Suspension
Dry Area False Ceiling Tiling / Boarding
Dry Area Painting - 1st Coat
Dry Area Flooring
Installation of Timber Doors & Ironmongery
Installation of Wardrobe
Paint Final Coat
Block Work in Wet Area
Marking,Cutting & Chasing - Wet Area
Sub frame Fixing/Plaster Preparation - Wet Area
Plaster in Wet Area
Wet Area Wall Tiling
Wet Area False Ceiling Suspension
Wet Area False Ceiling Tiling/Boarding
Wet Area Waterproofing
Wet Area Floor Screed
Wet Area Floor Tiling
Cabinet Carcass
Installation of Vanity Counters & Tops
Installation of Kitchen Cabinet
Installation of Shower Enclosure
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 54 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
Lift Lobby / Corridor 181.00 13-Jan-15 05-Jul-15 20-Jan-15 22-Aug-15 54.00 0% 0% 0.00
DHFSH39240 Corridor/Lift Lobby Floor Screed 4.00 13-Jan-15 17-Jan-15 20-Jan-15 24-Jan-15 35.00 0% 0% 0.00
DHFSH39270 Lift Lobby Painting - Primer & Stucco 6.00 18-Jan-15 24-Jan-15 25-Jan-15 31-Jan-15 35.00 0% 0% 0.00
DHFSH39310 Lift Lobby False Ceiling Suspension 6.00 11-Feb-15 18-Feb-15 09-Apr-15 16-Apr-15 -23.00 0% 0% 0.00
DHFSH39360 Lift Lobby False Ceiling Tiling / Boarding 5.00 28-Mar-15 01-Apr-15 20-Apr-15 26-Apr-15 74.00 0% 0% 0.00
DHFSH39410 Lift Lobby Painting - 1st Coat 6.00 02-Apr-15 08-Apr-15 05-Jul-15 11-Jul-15 15.00 0% 0% 0.00
DHFSH39440 Installation of Steel Doors & Windows 3.00 02-Jul-15 05-Jul-15 27-Jul-15 29-Jul-15 -19.00 0% 0% 0.00
DHFSH39470 Lift Lobby Flooring 6.00 09-May-15 14-May-15 09-Aug-15 15-Aug-15 54.00 0% 0% 0.00
DHFSH39490 Utility Rooms- Epoxy Flooring 6.00 17-May-15 23-May-15 16-Aug-15 22-Aug-15 54.00 0% 0% 0.00
Staircase 178.00 05-Jan-15 13-Jul-15 12-Jan-15 10-Aug-15 12.00 0% 0% 0.00
DHFSH39200 Staircase Plastering 4.00 05-Jan-15 08-Jan-15 12-Jan-15 15-Jan-15 137.00 0% 0% 0.00
DHFSH39280 Staircase Painting - Primer & Stucco 6.00 25-Jan-15 31-Jan-15 01-Feb-15 07-Feb-15 124.00 0% 0% 0.00
DHFSH39320 Staircase Handrail Fixing 3.00 31-Mar-15 04-Apr-15 11-Feb-15 14-Feb-15 140.00 0% 0% 0.00
DHFSH39330 Staircase Painting 1st Coat 3.00 22-Apr-15 25-Apr-15 27-Jul-15 29-Jul-15 4.00 0% 0% 0.00
DHFSH39340 Staircase Final Painting 5.00 06-Jul-15 11-Jul-15 30-Jul-15 04-Aug-15 15.00 0% 0% 0.00
DHFSH39380 Staircase Epoxy Flooring 2.00 12-Jul-15 13-Jul-15 09-Aug-15 10-Aug-15 12.00 0% 0% 0.00
General 329.00 05-Nov-14 17-Oct-15 10-Nov-14 08-Dec-15 -9.00 0% 0% 0.00
DHSTR39000 Access from Structure 0.00 05-Nov-14 10-Nov-14 4.00 0% 0% 0.00
DHFSH39510 Snagging & De-Snagging 12.00 03-Oct-15 17-Oct-15 24-Nov-15 08-Dec-15 -9.00 0% 0% 0.00
MEP - LEVEL 39 333.00 11-Oct-14 22-Sep-15 14-Oct-14 16-Nov-15 -9.00 0% 0% 0.00
DHMEP39000 Embeded Conduits & Boxex - Concrete Works 3.00 11-Oct-14 13-Oct-14 14-Oct-14 16-Oct-14 23.00 0% 0% 0.00
DHMEP39100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C15a-bNlionvg- 1, 4Wiring et0c6-Dec-14 20-Nov-14 11-Dec-14 -5.00 0% 0% 0.00
DHMEP39130 Cable Trays & Cable Trunking 6.00 14-Dec-14 20-Dec-14 21-Dec-14 27-Dec-14 53.00 0% 0% 0.00
DHMEP39120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 18-Dec-14 24-Dec-14 25-Dec-14 31-Dec-14 35.00 0% 0% 0.00
DHMEP39160 Pressure Testing of Pipes 12.00 25-Dec-14 08-Jan-15 03-Jan-15 15-Jan-15 62.00 0% 0% 0.00
DHMEP39110 MEP Works in Risers& Clearance 5.00 08-Feb-15 12-Feb-15 18-Mar-15 23-Mar-15 -33.00 0% 0% 0.00
DHMEP39140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es21-Mar-15 26-Mar-15 13-Apr-15 20-Apr-15 -14.00 0% 0% 0.00
DHMEP39150 MEP Final Fixes 6.00 05-Sep-15 10-Sep-15 29-Oct-15 04-Nov-15 -9.00 0% 0% 0.00
DHMEP06570 Sanitary ware /Toilet accessories 6.00 08-Sep-15 14-Sep-15 02-Nov-15 08-Nov-15 -9.00 0% 0% 0.00
DHMEP39200 Pre-Testing & Commissioning 7.00 15-Sep-15 22-Sep-15 09-Nov-15 16-Nov-15 -9.00 0% 0% 0.00
LEVEL 40 358.00 02-Oct-14 20-Oct-15 09-Oct-14 12-Dec-15 -9.00 0% 0% 0.00
LEVEL 41 383.00 09-Oct-14 24-Oct-15 14-Oct-14 14-Jan-16 -35.00 0% 0% 0.00
LEVEL 42 356.00 14-Oct-14 27-Oct-15 19-Oct-14 19-Dec-15 -9.00 0% 0% 0.00
LEVEL 43 354.00 20-Oct-14 31-Oct-15 26-Oct-14 22-Dec-15 -9.00 0% 0% 0.00
LEVEL 44 353.00 26-Oct-14 04-Nov-15 30-Oct-14 26-Dec-15 -9.00 0% 0% 0.00
LEVEL 45 355.00 30-Oct-14 11-Nov-15 04-Nov-14 02-Jan-16 -9.00 0% 0% 0.00
LEVEL 46 372.00 04-Nov-14 16-Nov-15 09-Nov-14 26-Jan-16 -27.00 0% 0% 0.00
LEVEL 47 352.00 10-Nov-14 21-Nov-15 15-Nov-14 09-Jan-16 -9.00 0% 0% 0.00
LEVEL 48 350.00 16-Nov-14 25-Nov-15 20-Nov-14 12-Jan-16 -9.00 0% 0% 0.00
LEVEL 49 349.00 20-Nov-14 30-Nov-15 25-Nov-14 16-Jan-16 -9.00 0% 0% 0.00
LEVEL 50 348.00 25-Nov-14 06-Dec-15 30-Nov-14 19-Jan-16 -9.00 0% 0% 0.00
LEVEL 51 360.00 30-Nov-14 10-Dec-15 06-Dec-14 07-Feb-16 -22.00 0% 0% 0.00
LEVEL 52 346.00 06-Dec-14 15-Dec-15 10-Dec-14 26-Jan-16 -9.00 0% 0% 0.00
LEVEL 53 345.00 10-Dec-14 20-Dec-15 15-Dec-14 30-Jan-16 -9.00 0% 0% 0.00
LEVEL 54 344.00 15-Dec-14 24-Dec-15 20-Dec-14 02-Feb-16 -9.00 0% 0% 0.00
LEVEL 55 343.00 20-Dec-14 29-Dec-15 24-Dec-14 06-Feb-16 -9.00 0% 0% 0.00
LEVEL 56 350.00 24-Dec-14 03-Jan-16 29-Dec-14 18-Feb-16 -17.00 0% 0% 0.00
LEVEL 57 329.00 29-Dec-14 07-Jan-16 04-Jan-15 30-Jan-16 -19.00 0% 0% 0.00
LEVEL 58 332.00 03-Jan-15 14-Jan-16 07-Jan-15 06-Feb-16 -19.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Corridor/Lift Lobby Floor Screed
Lift Lobby Painting - Primer & Stucco
Lift Lobby False Ceiling Suspension
Lift Lobby False Ceiling Tiling / Boarding
Lift Lobby Painting - 1st Coat
Installation of Steel Doors & Windows
Lift Lobby Flooring
Utility Rooms- Epoxy Flooring
Staircase Plastering
Staircase Painting - Primer & Stucco
Staircase Handrail Fixing
Staircase Painting 1st Coat
Staircase Final Painting
Staircase Epoxy Flooring
Access from Structure
Snagging & De-Snagging
Embeded Conduits & Boxex - Concrete Works
H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc
Cable Trays & Cable Trunking
Embeded Condiuts,Boxes and Sleeves in Walls
Pressure Testing of Pipes
MEP Works in Risers& Clearance
Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes
MEP Final Fixes
Sanitary ware /Toilet accessories
Pre-Testing & Commissioning
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 55 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
LEVEL 59 333.00 06-Jan-15 19-Jan-16 11-Jan-15 10-Feb-16 -19.00 0% 0% 0.00
LEVEL 60 332.00 11-Jan-15 23-Jan-16 15-Jan-15 14-Feb-16 -19.00 0% 0% 0.00
LEVEL 61 348.00 14-Jan-15 26-Jan-16 19-Jan-15 07-Mar-16 -35.00 0% 0% 0.00
LEVELS 62 (MECHANICAL FLOOR) 350.00 18-Jan-15 28-Jan-16 22-Jan-15 13-Mar-16 -38.00 0% 0% 0.00
LEVELS 63-85 395.00 25-Jan-15 19-Mar-16 29-Jan-15 12-May-16 -39.00 0% 0% 0.00
LEVEL 85(MECHANICAL FLOOR) 315.00 30-Apr-15 21-Mar-16 05-May-15 15-May-16 -44.00 0% 0% 0.00
LEVEL 86 TO ROOF 324.00 06-May-15 06-Apr-16 11-May-15 31-May-16 -46.00 0% 0% 0.00
ROOFING & WATERPROOFING SYSTEM 20.00 17-May-15 08-Jun-15 21-May-15 13-Jun-15 49.00 0% 0% 0.00
SPECIALIST WORKS 120.00 11-Oct-15 23-Mar-16 10-Dec-15 27-Apr-16 -17.00 0% 0% 0.00
FACADE WORKS 582.00 19-Jul-14 19-Jan-16 15-Jul-14 A 27-Aug-16 -178.00 11.43% 1.94% 0.17
STONE CLADDING -PODIUM 135.00 09-May-15 19-Oct-15 13-May-15 24-Oct-15 82.00 0% 0% 0.00
FACADE CLADDING 359.00 23-Jul-14 12-Nov-15 15-Jul-14 A 13-Jan-16 -51.00 12.38% 2.1% 0.17
DHFCDGNT00 Curtain Wall Glazing - Level L6-10 39.00 23-Jul-14 09-Sep-14 15-Jul-14 A 30-Oct-14 -57.00 100% 20% 0.20
DHFCDGNT01 Curtain Wall Glazing - Level 11-16 45.00 11-Aug-14 02-Oct-14 13-Aug-14 A 23-Nov-14 -57.00 95.83% 15% 0.16
DHFCDGNT02 Curtain Wall Glazing - Level 17-22 45.00 04-Sep-14 30-Oct-14 09-Sep-14 A 18-Dec-14 -57.00 49.17% 5% 0.10
DHFCDGNT03 Curtain Wall Glazing - Level 23-29 45.00 29-Sep-14 24-Nov-14 22-Sep-14 A 13-Jan-15 -57.00 2.5% 2% 0.80
DHFCDGNT04 Aluminum Louvers - Level 30 12.00 15-Nov-14 29-Nov-14 05-Jan-15 18-Jan-15 -41.00 0% 0% 0.00
DHFCDGNT05 Curtain Wall Glazing - Level 30 18.00 12-Nov-14 04-Dec-14 14-Jan-15 04-Feb-15 -51.00 0% 0% 0.00
DHFCDGNT06 Curtain Wall Glazing - Level 31-36 45.00 05-Nov-14 29-Dec-14 07-Jan-15 01-Mar-15 -51.00 0% 0% 0.00
DHFCDGNT07 Curtain Wall Glazing - Level 37-42 45.00 30-Nov-14 24-Jan-15 01-Feb-15 25-Mar-15 -51.00 0% 0% 0.00
DHFCDGNT08 Curtain Wall Glazing - Level 43-48 45.00 25-Dec-14 17-Feb-15 25-Feb-15 19-Apr-15 -51.00 0% 0% 0.00
DHFCDGNT09 Curtain Wall Glazing - Level 49-54 45.00 20-Jan-15 14-Mar-15 22-Mar-15 13-May-15 -51.00 0% 0% 0.00
DHFCDGNT11 Curtain Wall Glazing - Level 55-56 14.00 04-Mar-15 21-Mar-15 04-May-15 21-May-15 -51.00 0% 0% 0.00
DHFCDGNT12 Curtain Wall Glazing - Level 57-61 45.00 18-Feb-15 12-Apr-15 20-Apr-15 13-Jun-15 -51.00 0% 0% 0.00
DHFCDGNT10 Aluminum Louvers - Level 62 12.00 02-Apr-15 16-Apr-15 03-Jun-15 17-Jun-15 -51.00 0% 0% 0.00
DHFCDGNT13 Curtain Wall Glazing - Level 62 18.00 04-Apr-15 25-Apr-15 04-Jun-15 25-Jun-15 -51.00 0% 0% 0.00
DHFCDGNT14 Curtain Wall Glazing - Level 63-68 45.00 26-Mar-15 18-May-15 26-May-15 20-Jul-15 -51.00 0% 0% 0.00
DHFCDGNT15 Curtain Wall Glazing - Level 69-74 45.00 21-Apr-15 13-Jun-15 21-Jun-15 15-Aug-15 -51.00 0% 0% 0.00
DHFCDGNT17 Curtain Wall Glazing - Level 75-80 45.00 28-May-15 21-Jul-15 29-Jul-15 20-Sep-15 -51.00 0% 0% 0.00
DHFCDGNT18 Curtain Wall Glazing - Level 81-84 30.00 01-Jul-15 06-Aug-15 01-Sep-15 08-Oct-15 -51.00 0% 0% 0.00
DHFCDGNT16 Aluminum Louvers & Cladding - Level 85 18.00 26-Jul-15 15-Aug-15 26-Sep-15 18-Oct-15 -51.00 0% 0% 0.00
DHFCDGNT19 Facade Cladding - Level 86 Above - APEX 60.00 01-Sep-15 12-Nov-15 03-Nov-15 13-Jan-16 -51.00 0% 0% 0.00
FACADE LIGHTING 381.00 20-Oct-14 19-Jan-16 31-May-15 27-Aug-16 -182.00 0% 0% 0.00
FACADE CLEANING SYSTEM 389.00 19-Jul-14 29-Oct-15 01-Oct-14 11-Jan-16 -58.00 0% 0% 0.00
CONVEYING SYSTEM 437.00 24-Aug-14 22-Feb-16 24-Aug-14 A 07-Mar-16 0.00 9.42% 20.63% 2.19
LIFT 437.00 24-Aug-14 22-Feb-16 24-Aug-14 A 07-Mar-16 0.00 9.42% 20.63% 2.19
LIFTS - (L1-L6) 437.00 24-Aug-14 22-Feb-16 24-Aug-14 A 07-Mar-16 0.00 25% 25% 1.00
DHLFTGNL00 Template & Plumbing 20.00 24-Aug-14 15-Sep-14 24-Aug-14 A 28-Sep-14 A 100% 100% 1.00
DHLFTGNL05 Control Panel Installation & Wiring 25.00 17-Sep-14 18-Oct-14 01-Oct-14 02-Nov-14 0.00 48% 0% 0.00
DHLFTGNL01 Bracket Fixing 60.00 01-Oct-14 14-Dec-14 18-Oct-14 28-Dec-14 0.00 0% 0% 0.00
DHLFTGNL02 Rail Fixing 80.00 28-Oct-14 31-Jan-15 11-Nov-14 14-Feb-15 0.00 0% 0% 0.00
DHLFTGNL04 Machine Room Equipment Installation 12.00 12-Feb-15 25-Feb-15 17-Feb-15 02-Mar-15 9.00 0% 0% 0.00
DHLFTGNL03 Entrance & Door Fixing 90.00 20-Nov-14 07-Mar-15 06-Dec-14 21-Mar-15 0.00 0% 0% 0.00
DHLFTGNL06 Counter Weight Frame Installation 7.00 04-Mar-15 11-Mar-15 18-Mar-15 25-Mar-15 0.00 0% 0% 0.00
DHLFTGNL07 Cabin Assembly 10.00 05-Mar-15 16-Mar-15 19-Mar-15 30-Mar-15 0.00 0% 0% 0.00
DHLFTGNL08 Pit Equipment Installation 4.00 17-Mar-15 21-Mar-15 31-Mar-15 04-Apr-15 0.00 0% 0% 0.00
DHLFTGNL09 Roping 6.00 22-Mar-15 28-Mar-15 05-Apr-15 11-Apr-15 0.00 0% 0% 0.00
DHLFTGNL10 Hoist way & Cabin Wiring 6.00 29-Mar-15 04-Apr-15 12-Apr-15 18-Apr-15 0.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Curtain Wall Glazing - Level L6-10
Curtain Wall Glazing - Level 11-16
Curtain Wall Glazing - Level 17-22
Curtain Wall Glazing - Level 23-29
Aluminum Louvers - Level 30
Curtain Wall Glazing - Level 30
Curtain Wall Glazing - Level 31-36
Curtain Wall Glazing - Level 37-42
Curtain Wall Glazing - Level 43-48
Curtain Wall Glazing - Level 49-54
Curtain Wall Glazing - Level 55-56
Curtain Wall Glazing - Level 57-61
Aluminum Louvers - Level 62
Curtain Wall Glazing - Level 62
Curtain Wall Glazing - Level 63-68
Curtain Wall Glazing - Level 69-74
Curtain Wall Glazing - Level 75-80
Curtain Wall Glazing - Level 81-84
Aluminum Louvers & Cladding - Level Template & Plumbing
Control Panel Installation & Wiring
Bracket Fixing
Rail Fixing
Machine Room Equipment Installation
Entrance & Door Fixing
Counter Weight Frame Installation
Cabin Assembly
Pit Equipment Installation
Roping
Hoist way & Cabin Wiring
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 56 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHLFTGNL11 Lift Car Works 6.00 05-Apr-15 11-Apr-15 19-Apr-15 25-Apr-15 0.00 0% 0% 0.00
DHLFTGNL12 Testing 14.00 16-Apr-15 02-May-15 30-Apr-15 17-May-15 0.00 0% 0% 0.00
DHLFTGNL22 Final finishes & Testing & Commissioing 247.00 03-May-15 22-Feb-16 18-May-15 07-Mar-16 0.00 0% 0% 0.00
LIFTS - (M7-M9) 428.00 24-Aug-14 22-Feb-16 24-Aug-14 A 25-Feb-16 -3.00 12.69% 25% 1.97
DHLFTGNM00 Template & Plumbing 65.00 24-Aug-14 10-Nov-14 24-Aug-14 A 28-Sep-14 A 50.77% 100% 1.97
DHLFTGNM05 Control Panel Installation & Wiring 18.00 11-Nov-14 01-Dec-14 01-Oct-14 23-Oct-14 32.00 0% 0% 0.00
DHLFTGNM01 Bracket Fixing 60.00 20-Nov-14 31-Jan-15 13-Oct-14 23-Dec-14 32.00 0% 0% 0.00
DHLFTGNM02 Rail Fixing 70.00 08-Dec-14 28-Feb-15 30-Oct-14 21-Jan-15 32.00 0% 0% 0.00
DHLFTGNM03 Entrance & Door Fixing 75.00 31-Dec-14 29-Mar-15 23-Nov-14 19-Feb-15 32.00 0% 0% 0.00
DHLFTGNM04 Machine Room Equipment Installation- L68 12.00 05-Mar-15 18-Mar-15 10-Mar-15 23-Mar-15 -3.00 0% 0% 0.00
DHLFTGNM06 Counter Weight Frame Installation 30.00 30-Mar-15 03-May-15 02-Apr-15 06-May-15 -3.00 0% 0% 0.00
DHLFTGNM07 Cabin Assembly 7.00 02-May-15 09-May-15 05-May-15 12-May-15 -3.00 0% 0% 0.00
DHLFTGNM08 Pit Equipment Installation 7.00 10-May-15 18-May-15 13-May-15 21-May-15 -3.00 0% 0% 0.00
DHLFTGNM09 Roping 7.00 19-May-15 26-May-15 23-May-15 30-May-15 -3.00 0% 0% 0.00
DHLFTGNM10 Hoist way & Cabin Wiring 7.00 27-May-15 03-Jun-15 31-May-15 07-Jun-15 -3.00 0% 0% 0.00
DHLFTGNM11 Lift Car Finishes 8.00 04-Jun-15 13-Jun-15 08-Jun-15 16-Jun-15 -3.00 0% 0% 0.00
DHLFTGNM12 Testing & ready for CTU 14.00 14-Jun-15 29-Jun-15 17-Jun-15 02-Jul-15 -3.00 0% 0% 0.00
DHLFTGNM22 Final finishes & Testing & Commissioing 198.00 30-Jun-15 22-Feb-16 04-Jul-15 25-Feb-16 -3.00 0% 0% 0.00
LIFTS - (H10-H11) 424.00 12-Oct-14 22-Feb-16 24-Aug-14 A 21-Feb-16 1.00 0% 25% 0.00
DHLFTGNH00 Template & Plumbing 30.00 12-Oct-14 16-Nov-14 24-Aug-14 A 28-Sep-14 A 0% 100% 0.00
DHLFTGNH05 Control Panel Installation & Wiring 24.00 17-Nov-14 15-Dec-14 01-Oct-14 01-Nov-14 37.00 0% 0% 0.00
DHLFTGNH01 Bracket Fixing 85.00 31-Dec-14 09-Apr-15 17-Nov-14 25-Feb-15 37.00 0% 0% 0.00
DHLFTGNH02 Rail Fixing 95.00 18-Jan-15 07-May-15 04-Dec-14 25-Mar-15 37.00 0% 0% 0.00
DHLFTGNH03 Entrance & Door Fixing 85.00 16-Feb-15 26-May-15 04-Jan-15 12-Apr-15 37.00 0% 0% 0.00
DHLFTGNH04 Machine Room Equipment Installation 12.00 25-May-15 07-Jun-15 24-May-15 06-Jun-15 1.00 0% 0% 0.00
DHLFTGNH06 Counter Weight Frame Installation 12.00 08-Jun-15 21-Jun-15 07-Jun-15 20-Jun-15 1.00 0% 0% 0.00
DHLFTGNH07 Cabin Assembly 8.00 20-Jun-15 28-Jun-15 18-Jun-15 27-Jun-15 1.00 0% 0% 0.00
DHLFTGNH08 Pit Equipment Installation 6.00 29-Jun-15 05-Jul-15 28-Jun-15 04-Jul-15 1.00 0% 0% 0.00
DHLFTGNH09 Roping 9.00 30-Jun-15 09-Jul-15 29-Jun-15 08-Jul-15 1.00 0% 0% 0.00
DHLFTGNH10 Hoist way & Cabin Wiring 7.00 08-Jul-15 15-Jul-15 07-Jul-15 14-Jul-15 1.00 0% 0% 0.00
DHLFTGNH11 Lift Car Finishes 7.00 16-Jul-15 26-Jul-15 15-Jul-15 25-Jul-15 1.00 0% 0% 0.00
DHLFTGNH12 Testing & ready for CTU 14.00 27-Jul-15 11-Aug-15 26-Jul-15 10-Aug-15 1.00 0% 0% 0.00
DHLFTGNH32 Final finishes & Testing & Commissioing 163.00 12-Aug-15 22-Feb-16 11-Aug-15 21-Feb-16 1.00 0% 0% 0.00
LIFTS - (H12) 413.00 18-Oct-14 22-Feb-16 24-Aug-14 A 21-Feb-16 1.00 0% 7.5% 0.00
DHLFTGNH13 Template & Plumbing 30.00 18-Oct-14 22-Nov-14 24-Aug-14 A 10-Nov-14 10.00 0% 30% 0.00
DHLFTGNH18 Control Panel Installation & Wiring 24.00 23-Nov-14 21-Dec-14 11-Nov-14 09-Dec-14 10.00 0% 0% 0.00
DHLFTGNH14 Bracket Fixing 90.00 25-Nov-14 11-Mar-15 13-Nov-14 28-Feb-15 10.00 0% 0% 0.00
DHLFTGNH15 Rail Fixing 90.00 22-Dec-14 06-Apr-15 10-Dec-14 25-Mar-15 10.00 0% 0% 0.00
DHLFTGNH16 Entrance & Door Fixing 100.00 27-Jan-15 24-May-15 15-Jan-15 11-May-15 10.00 0% 0% 0.00
DHLFTGNH17 Machine Room Equipment Installation 12.00 21-May-15 03-Jun-15 20-May-15 02-Jun-15 1.00 0% 0% 0.00
DHLFTGNH19 Counter Weight Frame Installation 12.00 04-Jun-15 17-Jun-15 03-Jun-15 16-Jun-15 1.00 0% 0% 0.00
DHLFTGNH20 Cabin Assembly 12.00 10-Jun-15 23-Jun-15 09-Jun-15 22-Jun-15 1.00 0% 0% 0.00
DHLFTGNH21 Pit Equipment Installation 7.00 24-Jun-15 01-Jul-15 23-Jun-15 30-Jun-15 1.00 0% 0% 0.00
DHLFTGNH22 Roping 11.00 25-Jun-15 07-Jul-15 24-Jun-15 06-Jul-15 1.00 0% 0% 0.00
DHLFTGNH23 Hoist way & Cabin Wiring 10.00 02-Jul-15 13-Jul-15 01-Jul-15 12-Jul-15 1.00 0% 0% 0.00
DHLFTGNH24 Lift Car Finishes 6.00 14-Jul-15 22-Jul-15 13-Jul-15 21-Jul-15 1.00 0% 0% 0.00
DHLFTGNH25 Testing & ready for CTU 14.00 23-Jul-15 08-Aug-15 22-Jul-15 06-Aug-15 1.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Lift Car Works
Testing
Template & Plumbing
Control Panel Installation & Wiring
Bracket Fixing
Rail Fixing
Entrance & Door Fixing
Machine Room Equipment Installation- L68
Counter Weight Frame Installation
Cabin Assembly
Pit Equipment Installation
Roping
Hoist way & Cabin Wiring
Lift Car Finishes
Testing & ready for CTU
Template & Plumbing
Control Panel Installation & Wiring
Bracket Fixing
Rail Fixing
Entrance & Door Fixing
Machine Room Equipment Installation
Counter Weight Frame Installation
Cabin Assembly
Pit Equipment Installation
Roping
Hoist way & Cabin Wiring
Lift Car Finishes
Testing & ready for CTU
Template & Plumbing
Control Panel Installation & Wiring
Bracket Fixing
Rail Fixing
Entrance & Door Fixing
Machine Room Equipment Installation
Counter Weight Frame Installation
Cabin Assembly
Pit Equipment Installation
Roping
Hoist way & Cabin Wiring
Lift Car Finishes
Testing & ready for CTU
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 57 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
Activity ID Activity Name Original
Duration
Planned Start Planned Finish Actual/Forecast
Start
Actual/Forecast
Finish
Total
Float
Planned %
Complete
Actual %
Complete
SPI
2014 2015
DHLFTGNH35 Final finishes & Testing & Commissioing 66.00 08-Dec-15 22-Feb-16 07-Dec-15 21-Feb-16 1.00 0% 0% 0.00
GARBAGE CHUTE 330.00 30-Aug-14 04-Oct-15 02-Sep-14 A 02-Nov-15 -23.00 3.42% 0.38% 0.11
LEVEL GF-28 110.00 30-Aug-14 11-Jan-15 02-Sep-14 A 17-Jan-15 4.00 16.05% 2% 0.12
DHGRBGNG00 Frame Fixing GF-L28 80.00 30-Aug-14 06-Dec-14 02-Sep-14 A 05-Jan-15 -8.00 33.91% 2% 0.06
DHGRBGNG01 Installation of Water Supply & FF Risers GF-L28 80.00 10-Sep-14 17-Dec-14 02-Sep-14 A 05-Jan-15 0.00 21.41% 2% 0.09
DHGRBGNG02 Electrical Conduiting & Wiring GF-L28 80.00 22-Sep-14 29-Dec-14 02-Sep-14 A 05-Jan-15 4.00 8.91% 2% 0.22
DHGRBGNG03 Chute Installation GF-L28 80.00 06-Oct-14 11-Jan-15 02-Sep-14 A 17-Jan-15 4.00 0% 2% 0.00
LEVEL 29-56 102.00 06-Dec-14 14-Apr-15 06-Jan-15 04-May-15 -8.00 0% 0% 0.00
DHGRBGN290 Frame Fixing L29-L56 80.00 06-Dec-14 10-Mar-15 06-Jan-15 08-Apr-15 -8.00 0% 0% 0.00
DHGRBGN291 Installation of Water Supply & FF Risers L29-L56 80.00 17-Dec-14 22-Mar-15 15-Jan-15 18-Apr-15 -8.00 0% 0% 0.00
DHGRBGN292 Electrical Conduiting & Wiring L29-L56 80.00 29-Dec-14 02-Apr-15 25-Jan-15 27-Apr-15 -8.00 0% 0% 0.00
DHGRBGN293 Chute Installation L29-L56 80.00 11-Jan-15 14-Apr-15 01-Feb-15 04-May-15 -8.00 0% 0% 0.00
LEVEL 57-80 92.00 10-Mar-15 06-Jul-15 09-Apr-15 28-Jul-15 -8.00 0% 0% 0.00
DHGRBGN570 Frame Fixing L57-L80 70.00 10-Mar-15 01-Jun-15 09-Apr-15 30-Jun-15 2.00 0% 0% 0.00
DHGRBGN571 Installation of Water Supply & FF Risers L57-L80 70.00 22-Mar-15 13-Jun-15 19-Apr-15 09-Jul-15 -2.00 0% 0% 0.00
DHGRBGN572 Electrical Conduiting & Wiring L57-L80 70.00 02-Apr-15 24-Jun-15 28-Apr-15 21-Jul-15 -6.00 0% 0% 0.00
DHGRBGN573 Chute Installation L57-L80 70.00 14-Apr-15 06-Jul-15 05-May-15 28-Jul-15 -8.00 0% 0% 0.00
LEVEL 81 to Roof 62.00 07-May-15 01-Aug-15 08-Jun-15 20-Aug-15 -8.00 0% 0% 0.00
DHGRBGN810 Frame Fixing L81- Roof 20.00 07-May-15 01-Jun-15 08-Jun-15 30-Jun-15 22.00 0% 0% 0.00
DHGRBGN811 Installation of Water Supply & FF Risers L81- Roof 20.00 20-May-15 13-Jun-15 17-Jun-15 09-Jul-15 18.00 0% 0% 0.00
DHGRBGN812 Electrical Conduiting & Wiring L81- Roof 20.00 01-Jun-15 24-Jun-15 27-Jun-15 21-Jul-15 14.00 0% 0% 0.00
DHGRBGN813 Chute Installation L81- Roof 20.00 06-Jul-15 01-Aug-15 29-Jul-15 20-Aug-15 -8.00 0% 0% 0.00
LEVEL GF-Roof (ALL LEVELS) 330.00 03-Sep-14 04-Oct-15 01-Oct-14 02-Nov-15 -23.00 1.54% 0% 0.00
DHGRBGN000 MEP Termination to Chute 158.00 18-Feb-15 25-Aug-15 11-Mar-15 14-Sep-15 -8.00 0% 0% 0.00
DHGRBGN001 Civil Finishes 312.00 03-Sep-14 10-Sep-15 01-Oct-14 11-Oct-15 -23.00 7.69% 0% 0.00
DHGRBGN002 Door Installation & Final Electrical Connections 250.00 25-Nov-14 17-Sep-15 24-Dec-14 19-Oct-15 -23.00 0% 0% 0.00
DHGRBGN003 Ventilation Fans 12.00 05-Sep-15 17-Sep-15 05-Oct-15 19-Oct-15 -23.00 0% 0% 0.00
DHGRBGN004 Panel Installation 12.00 19-Sep-15 04-Oct-15 20-Oct-15 02-Nov-15 -23.00 0% 0% 0.00
FINISHES AFTER DISMANTLING UTILITIES 318.00 17-May-15 13-Apr-16 21-May-15 04-Jun-16 -42.00 0% 0% 0.00
CLOSEOUT ( SNAGGING , COMMISSIONING & AS BUILTS) 427.00 22-Jul-15 14-May-16 28-Jul-15 20-Dec-16 -182.00 0% 0% 0.00
DHCHNGN210 Preparing & Submitting As built Drawings 150.00 22-Jul-15 17-Jan-16 28-Jul-15 23-Jan-16 33.00 0% 0% 0.00
DHCHNGN220 Preparing and Submitting Final O&M manuals 55.00 22-Nov-15 25-Jan-16 28-Nov-15 31-Jan-16 33.00 0% 0% 0.00
DHCHNGN230 Preparing and Submitting close out Documents 25.00 01-Mar-16 29-Mar-16 30-Jun-16 31-Jul-16 -65.00 0% 0% 0.00
DHCHNGN200 Overall Testing & Commissioning Works 120.00 17-Dec-15 05-May-16 20-Jul-16 11-Dec-16 -182.00 0% 0% 0.00
DHCHNGN300 Overall Snagging & Handing Over 90.00 30-Jan-16 14-May-16 01-Sep-16 20-Dec-16 -182.00 0% 0% 0.00
DHCHNGN500 Overall Completion 0.00 14-May-16 20-Dec-16 -182.00 0% 0% 0.00
Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec
Frame Fixing GF-L28
Installation of Water Supply & FF Risers GF-L28
Electrical Conduiting & Wiring GF-L28
Chute Installation GF-L28
Frame Fixing L29-L56
Installation of Water Supply & FF Risers L29-L56
Electrical Conduiting & Wiring L29-L56
Chute Installation L29-L56
Frame Fixing L57-L80
Installation of Water Supply & FF Risers L57-L80
Electrical Conduiting & Wiring L57-L80
Chute Installation L57-L80
Frame Fixing L81- Roof
Installation of Water Supply & FF Risers L81- Roof
Electrical Conduiting & Wiring L81- Roof
Chute Installation L81- Roof
MEP Termination to Chute
Civil Finishes
Door Installation & Final Electrical Ventilation Fans
Panel Installation
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 58 of 58
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Project Progress Update as of 30-Sep-2014
Taregt Completion Programme - Rev 03
Date Revision Chec... Appr...
20-Aug-14 Target Completion Programme - Rev 03 (Baseline)
30-Sep-14 Schedule Update - September-14 (Update) SK
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 2
Structure Delay
Activity ID Activity Name Current
Duration
DAMAC Gulf Properties L.L.C
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
Total 1288.00 24-Feb-14 12-Aug-15 26-Jun-11 A 17-Aug-15 57.12% 56.34% 7.00
DAMAC HEIGHTS-Target Completion Programme- Rev 3.1 1288.00 24-Feb-14 12-Aug-15 26-Jun-11 A 17-Aug-15 57.12% 56.34% 7.00
CONSTRUCTION 1288.00 24-Feb-14 12-Aug-15 26-Jun-11 A 17-Aug-15 57.12% 56.34% 7.00
STRUCTURAL , ARCHITECTURAL , MEP 1288.00 24-Feb-14 12-Aug-15 26-Jun-11 A 17-Aug-15 57.12% 56.34% 7.00
FOUNDATION WORKS 1099.00 24-Feb-14 29-Nov-14 26-Jun-11 A 05-Jan-15 87.26% 83.62% -28.00
BASEMENT B05 (-16.00 FFL) 1099.00 24-Feb-14 29-Nov-14 26-Jun-11 A 05-Jan-15 87.26% 83.62% -28.00
STRUCTURAL B05 1099.00 24-Feb-14 29-Nov-14 26-Jun-11 A 05-Jan-15 87.26% 83.62% -28.00
ZONE A ( Area1,2 & 3) 88.00 24-Feb-14 24-Feb-14 26-Jun-11 A 06-Jun-13 A 100% 100%
ZONE B (Area 4) 371.00 24-Feb-14 29-Nov-14 19-Oct-13 A 05-Jan-15 59.91% 48.45% -28.00
Soil Work - Section BB 289.00 24-Feb-14 10-Aug-14 19-Oct-13 A 16-Oct-14 100% 98.75% 21.00
DHFNAB6200 Install 1st level of Struts @+2.46 DMD (B1 Level ) 14.00 24-Feb-14 24-Feb-14 19-Oct-13 A 07-Nov-13 A 100% 100%
DHFNAB6210 Excavation Works up to -4.0 DMD 8.00 24-Feb-14 24-Feb-14 19-Oct-13 A 12-Dec-13 A 100% 100%
DHFNAB6230 Destress Anchores at level -4.7 DMD 2.00 05-Jul-14 06-Jul-14 30-Jan-14 A 01-Feb-14 A 100% 100%
DHFNAB6220 Install 3rd level of Struts @-3.94 (B3 Level)-Sec B-B 27.00 24-Feb-14 24-Feb-14 12-Feb-14 A 12-Feb-14 A 100% 100%
DHFNAB6260 Destress Anchores at level B4-6.99 DMD 2.00 07-Jul-14 08-Jul-14 01-Aug-14 A 01-Aug-14 A 100% 100%
DHFNAB6240 Excavation works up to level B5-Sec B-B 25.00 09-Jul-14 09-Aug-14 12-Jul-14 A 15-Oct-14 100% 58% -18.00
DHFNAB6250 Demolition of Internal Diaphragm Wall up to B4 3.00 07-Aug-14 10-Aug-14 16-Aug-14 A 16-Oct-14 100% 94% 21.00
Soil Work - Section DD 290.00 10-Jul-14 23-Sep-14 12-Nov-13 A 01-Nov-14 100% 0% 12.00
DHFNAB6520 Excavation upto -3.79 DMD-B3 Lvl -Sec D-D 6.00 26-Jul-14 03-Aug-14 26-Jul-14 A 03-Aug-14 A 100% 100%
DHFNAB6500 Install 2nd level of Struts @-0.59 DMD (B2 Level)- Sec D-D14.00 10-Jul-14 24-Jul-14 12-Nov-13 A 14-Aug-14 A 100% 100%
DHFNAB6530 Strut Installation at -3.79 DMD-B3 Lvl -Sec D-D 14.00 04-Aug-14 19-Aug-14 04-Aug-14 A 19-Aug-14 A 100% 100%
DHFNAB6540 Excavation upto -6.99 DMD-B4 Lvl -Sec D-D 6.00 20-Aug-14 26-Aug-14 20-Aug-14 A 26-Aug-14 A 100% 100%
DHFNAB6510 Install 4th level of Struts @-6.99 (B4 Level)-Sec D-D 18.00 27-Aug-14 16-Sep-14 01-Oct-14 23-Oct-14 100% 0% -28.00
DHFNAB6270 Final Excavation Works up to B5 - Sec D-D 5.00 17-Sep-14 22-Sep-14 26-Oct-14 30-Oct-14 100% 0% -28.00
DHFNAB6280 Demolition of Remaining Internal Diaphragm Wall 3.00 21-Sep-14 23-Sep-14 29-Oct-14 01-Nov-14 100% 0% 12.00
Piles and RAFT 57.00 21-Sep-14 29-Nov-14 29-Oct-14 05-Jan-15 12.16% 0% -28.00
DHFNAB6290 Pile Integrity Test By Zetas 4.00 21-Sep-14 24-Sep-14 29-Oct-14 02-Nov-14 100% 0% -28.00
DHFNAB6300 Pile Head Trimming 6.00 25-Sep-14 01-Oct-14 03-Nov-14 09-Nov-14 83.33% 0% -28.00
DHFNAB6310 Dressing /Surface Preparation 4.00 02-Oct-14 08-Oct-14 10-Nov-14 13-Nov-14 0% 0% -28.00
DHFNAB6320 Anti termite/ Blinding & Pile Profiling 4.00 09-Oct-14 13-Oct-14 15-Nov-14 18-Nov-14 0% 0% -28.00
DHFNAB6350Waterproofing Works and Protection Screed 3.00 14-Oct-14 16-Oct-14 19-Nov-14 22-Nov-14 0% 0% -21.00
DHFNAB6330 Pile Head treatment 4.00 14-Oct-14 18-Oct-14 19-Nov-14 23-Nov-14 0% 0% -28.00
DHFNAB6340 Therma-cool Insulation Boards 4.00 14-Oct-14 18-Oct-14 19-Nov-14 23-Nov-14 0% 0% -28.00
DHFNAB6360 Vertical Protection Boards 6.00 19-Oct-14 26-Oct-14 24-Nov-14 30-Nov-14 0% 0% -28.00
DHFNAB6390Reinforcement Works of Tower crane Foundation inside Raft5.00 30-Oct-14 04-Nov-14 06-Dec-14 10-Dec-14 0% 0% -20.00
DHFNAB6370Rebar for Raft 15.00 27-Oct-14 12-Nov-14 01-Dec-14 18-Dec-14 0% 0% -28.00
DHFNAB6380MEP Works (Raft) 15.00 28-Oct-14 13-Nov-14 03-Dec-14 20-Dec-14 0% 0% -28.00
DHFNAB6400 Concrete Pour 1.00 15-Nov-14 15-Nov-14 21-Dec-14 21-Dec-14 0% 0% -28.00
DHCLBB3100Columns & Walls 6.00 16-Nov-14 22-Nov-14 22-Dec-14 28-Dec-14 0% 0% -27.00
DHRWBB310R0etaining Wall 12.00 16-Nov-14 29-Nov-14 22-Dec-14 05-Jan-15 0% 0% -28.00
STAIRCASES BASEMENT B05 99.00 24-Feb-14 16-Mar-14 05-Dec-13 A 22-Dec-13 A 0% 0%
DHSLAP5130 Stair # 3 8.00 24-Feb-14 24-Feb-14 05-Dec-13 A 10-Dec-13 A 100% 100%
DHSLAP5135 Stair # 1 4.00 16-Mar-14 16-Mar-14 08-Dec-13 A 13-Dec-13 A 100% 100%
DHSLAP5125 Stair # 2 5.00 16-Mar-14 16-Mar-14 17-Dec-13 A 22-Dec-13 A 100% 100%
BASEMENT & PODIUM 1169.00 24-Feb-14 04-Jun-15 31-May-13 A 09-Jul-15 81.24% 81.24% -28.00
BASEMENT B04 (-12.80 FFL) 1034.00 24-Feb-14 27-Dec-14 31-May-13 A 01-Feb-15 77.49% 77.49% -28.00
STRUCTURAL B04 1034.00 24-Feb-14 27-Dec-14 31-May-13 A 01-Feb-15 77.49% 77.49% -28.00
BASEMENT B04 (ZONE A) 36.00 24-Feb-14 24-Feb-14 31-May-13 A 11-Aug-13 A 100% 100%
2014 2015 2016 2017
Install 1st level of Struts @+2.46 DMD (B1 Level )
Excavation Works up to -4.0 DMD
Destress Anchores at level -4.7 DMD
Install 3rd level of Struts @-3.94 (B3 Level)-Sec B-B
Destress Anchores at level B4-6.99 DMD
Excavation works up to level B5-Sec B-B
Demolition of Internal Diaphragm Wall up to B4
Excavation upto -3.79 DMD-B3 Lvl -Sec D-D
Install 2nd level of Struts @-0.59 DMD (B2 Level)- Sec D-D
Strut Installation at -3.79 DMD-B3 Lvl -Sec D-D
Excavation upto -6.99 DMD-B4 Lvl -Sec D-D
Install 4th level of Struts @-6.99 (B4 Level)-Sec D-D
Final Excavation Works up to B5 - Sec D-D
Demolition of Remaining Internal Diaphragm Wall
Pile Integrity Test By Zetas
Pile Head Trimming
Dressing /Surface Preparation
Anti termite/ Blinding & Pile Profiling
Waterproofing Works and Protection Screed
Pile Head treatment
Therma-cool Insulation Boards
Vertical Protection Boards
Reinforcement Works of Tower crane Foundation inside Raft
Rebar for Raft
MEP Works (Raft)
Concrete Pour
Columns & Walls
Retaining Wall
Stair # 1
Stair # 2
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 1 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
BASEMENT B04 (ZONE B) 28.00 24-Nov-14 27-Dec-14 30-Dec-14 01-Feb-15 0% 0% -28.00
DHCLBB3110Removal Of Struts-B4 6.00 26-Nov-14 03-Dec-14 03-Jan-15 08-Jan-15 0% 0% -28.00
DHSLBB3100Construct Slab - Level B04 14.00 24-Nov-14 10-Dec-14 30-Dec-14 15-Jan-15 0% 0% -28.00
DHCLBB2100Columns & Walls 6.00 11-Dec-14 17-Dec-14 17-Jan-15 22-Jan-15 0% 0% -28.00
DHRWBB2100Retaining Wall 14.00 11-Dec-14 27-Dec-14 17-Jan-15 01-Feb-15 0% 0% -28.00
STAIRCASES BASEMENT B04 100.00 24-Feb-14 25-Mar-14 13-Dec-13 A 03-Feb-14 A 0% 0%
DHSLAP5205 Stair # 1 4.00 25-Mar-14 25-Mar-14 13-Dec-13 A 18-Dec-13 A 100% 100%
DHSLAP5270 Stair # 3 8.00 24-Feb-14 24-Feb-14 13-Dec-13 A 18-Dec-13 A 100% 100%
DHSLAP5215 Stair # 2 5.00 25-Mar-14 25-Mar-14 29-Jan-14 A 03-Feb-14 A 100% 100%
BASEMENT B03 (-9.60 FFL) 1046.00 24-Feb-14 15-Jan-15 19-Jun-13 A 19-Feb-15 77.49% 77.49% -28.00
STRUCTURAL B03 1046.00 24-Feb-14 15-Jan-15 19-Jun-13 A 19-Feb-15 77.49% 77.49% -28.00
BASEMENT B03 (ZONE A) 51.00 24-Feb-14 24-Feb-14 19-Jun-13 A 10-Sep-13 A 100% 100%
BASEMENT B03 (ZONE B) 24.00 18-Dec-14 15-Jan-15 24-Jan-15 19-Feb-15 0% 0% -28.00
DHSLBB2110Removal Of Struts-B3 6.00 21-Dec-14 27-Dec-14 26-Jan-15 01-Feb-15 0% 0% -28.00
DHSLBB2100Slab - Level B03 14.00 18-Dec-14 04-Jan-15 24-Jan-15 08-Feb-15 0% 0% -28.00
DHCLBB1100Columns & Walls 7.00 05-Jan-15 12-Jan-15 09-Feb-15 16-Feb-15 0% 0% -26.00
DHRWBB1100Retaining Wall 10.00 05-Jan-15 15-Jan-15 09-Feb-15 19-Feb-15 0% 0% -28.00
STAIRCASES BASEMENT B03 8.00 01-Apr-14 01-Apr-14 19-Dec-13 A 23-Feb-14 A 0% 0%
DHSLAP5145 Stair # 3 8.00 01-Apr-14 01-Apr-14 19-Dec-13 A 24-Dec-13 A 100% 100%
DHSLAP5150 Stair # 1 4.00 01-Apr-14 01-Apr-14 02-Feb-14 A 07-Feb-14 A 100% 100%
DHSLAP5140 Stair # 2 5.00 01-Apr-14 01-Apr-14 18-Feb-14 A 23-Feb-14 A 100% 100%
BASEMENT B02 (-6.40 FFL) 1060.00 24-Feb-14 07-Feb-15 30-Jun-13 A 14-Mar-15 77.49% 77.49% -23.00
STRUCTURAL B02 1060.00 24-Feb-14 07-Feb-15 30-Jun-13 A 14-Mar-15 77.49% 77.49% -23.00
BASEMENT B02 (ZONE A) 67.00 24-Feb-14 24-Feb-14 30-Jun-13 A 24-Sep-13 A 100% 100%
BASEMENT B02 (ZONE B) 25.00 10-Jan-15 07-Feb-15 14-Feb-15 14-Mar-15 0% 0% -23.00
DHCLBGF110Removal Of Struts-B2 6.00 10-Jan-15 15-Jan-15 14-Feb-15 19-Feb-15 0% 0% -25.00
DHSLBB1100Slab - Level B02 10.00 15-Jan-15 26-Jan-15 19-Feb-15 02-Mar-15 0% 0% -28.00
DHCLBGF100Columns & Walls 6.00 28-Jan-15 03-Feb-15 04-Mar-15 10-Mar-15 0% 0% -28.00
DHRWBGF100 Retaining Wall 10.00 27-Jan-15 07-Feb-15 03-Mar-15 14-Mar-15 0% 0% -23.00
STAIRCASES BASEMENT B02 10.00 08-Apr-14 08-Apr-14 24-Dec-13 A 23-Feb-14 A 0% 0%
DHSLAP5156 Stair # 3 8.00 08-Apr-14 08-Apr-14 24-Dec-13 A 29-Dec-13 A 100% 100%
DHSLAP5155 Stair # 2 5.00 08-Apr-14 08-Apr-14 12-Feb-14 A 17-Feb-14 A 100% 100%
DHSLAP5157 Stair # 1 4.00 08-Apr-14 08-Apr-14 18-Feb-14 A 23-Feb-14 A 100% 100%
BASEMENT B01 (-3.20 FFL) 1069.00 24-Feb-14 03-Mar-15 16-Jul-13 A 07-Apr-15 78.22% 78.22% -28.00
STRUCTURAL B01 1069.00 24-Feb-14 03-Mar-15 16-Jul-13 A 07-Apr-15 78.22% 78.22% -28.00
BASEMENT B01 (ZONE A) 619.00 24-Feb-14 24-Feb-14 16-Jul-13 A 22-Oct-13 A 100% 100%
BASEMENT B01 (ZONE B) 27.00 01-Feb-15 03-Mar-15 08-Mar-15 07-Apr-15 0% 0% -28.00
DHCLBP1110Removal Of Struts-B1 6.00 01-Feb-15 07-Feb-15 08-Mar-15 14-Mar-15 0% 0% -23.00
DHSLBGF100Slab - Level B01 14.00 04-Feb-15 19-Feb-15 11-Mar-15 26-Mar-15 0% 0% -28.00
DHCLBP1100Columns & Walls 10.00 21-Feb-15 03-Mar-15 28-Mar-15 07-Apr-15 0% 0% -28.00
STAIRCASES BASEMENT B01 12.00 12-Apr-14 15-Apr-14 01-Jan-14 A 15-Apr-14 A 0% 0%
DHSLAP5165 Stair # 3 8.00 15-Apr-14 15-Apr-14 01-Jan-14 A 06-Jan-14 A 100% 100%
DHSLAP5160 Stair # 2 5.00 15-Apr-14 15-Apr-14 14-Feb-14 A 19-Feb-14 A 100% 100%
DHSLAP5167 Stair # 1 4.00 12-Apr-14 15-Apr-14 12-Apr-14 A 15-Apr-14 A 100% 100%
GROUND FLOOR (000 FFL) 1067.00 24-Feb-14 23-Mar-15 22-Aug-13 A 27-Apr-15 78.69% 78.69% -28.00
STRUCTURAL GF 1067.00 24-Feb-14 23-Mar-15 22-Aug-13 A 27-Apr-15 78.69% 78.69% -28.00
GROUND FLOOR (ZONE A) 634.00 24-Feb-14 24-Feb-14 22-Aug-13 A 04-Nov-13 A 100% 100%
GROUND FLOOR (ZONE B) 17.00 04-Mar-15 23-Mar-15 08-Apr-15 27-Apr-15 0% 0% -28.00
DHSLBP1100Slab - Level GF 12.00 04-Mar-15 17-Mar-15 08-Apr-15 21-Apr-15 0% 0% -28.00
2014 2015 2016 2017
Removal Of Struts-B4
Construct Slab - Level B04
Columns & Walls
Retaining Wall
Stair # 1
Stair # 2
Removal Of Struts-B3
Slab - Level B03
Columns & Walls
Retaining Wall
Stair # 3
Stair # 1
Stair # 2
Removal Of Struts-B2
Slab - Level B02
Columns & Walls
Retaining Wall
Stair # 3
Stair # 2
Stair # 1
Removal Of Struts-B1
Slab - Level B01
Columns & Walls
Stair # 3
Stair # 2
Stair # 1
Slab - Level GF
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 2 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
DHCLBP2100Columns & Walls 5.00 18-Mar-15 23-Mar-15 22-Apr-15 27-Apr-15 0% 0% -28.00
STAIRCASES GROUND FLOOR 14.00 19-Apr-14 22-Apr-14 08-Jan-14 A 22-Apr-14 A 0% 0%
DHSLAP5175 Stair # 3 8.00 22-Apr-14 22-Apr-14 08-Jan-14 A 13-Jan-14 A 100% 100%
DHSLAP5170 Stair # 2 5.00 22-Apr-14 22-Apr-14 14-Feb-14 A 19-Feb-14 A 100% 100%
DHSLAP5180 Stair # 1 4.00 19-Apr-14 22-Apr-14 19-Apr-14 A 22-Apr-14 A 100% 100%
LEVEL P1 (+3.10 FFL) 1057.00 24-Feb-14 06-Apr-15 22-Aug-13 A 11-May-15 84.72% 84.72% -28.00
STRUCTURAL P1 1057.00 24-Feb-14 06-Apr-15 22-Aug-13 A 11-May-15 84.72% 84.72% -28.00
LEVEL P1 (ZONE A) 664.00 24-Feb-14 24-Feb-14 22-Aug-13 A 24-Nov-13 A 100% 100%
LEVEL P1 (ZONE B) 12.00 24-Mar-15 06-Apr-15 28-Apr-15 11-May-15 0% 0% -28.00
DHSLBP2100Slab - Level P1 7.00 24-Mar-15 31-Mar-15 28-Apr-15 05-May-15 0% 0% -28.00
DHCLBP3100Columns & Walls 5.00 01-Apr-15 06-Apr-15 06-May-15 11-May-15 0% 0% -28.00
STAIRCASES LEVEL P1 15.00 24-Apr-14 29-Apr-14 31-Jan-14 A 29-Apr-14 A 0% 0%
DHSLAP5190 Stair # 3 6.00 24-Apr-14 24-Apr-14 31-Jan-14 A 05-Feb-14 A 100% 100%
DHSLAP5195 Stair # 1 4.00 26-Apr-14 29-Apr-14 26-Apr-14 A 29-Apr-14 A 100% 100%
DHSLAP5185 Stair # 2 5.00 24-Apr-14 29-Apr-14 24-Apr-14 A 29-Apr-14 A 100% 100%
LEVEL P2 (+6.20 FFL) 470.00 24-Feb-14 20-Apr-15 20-Oct-13 A 26-May-15 84.73% 84.73% -28.00
STRUCTURAL P2 470.00 24-Feb-14 20-Apr-15 20-Oct-13 A 26-May-15 84.73% 84.73% -28.00
LEVEL P2 (ZONE A) 72.00 24-Feb-14 24-Feb-14 20-Oct-13 A 13-Dec-13 A 100% 100%
LEVEL P2 (ZONE B) 12.00 07-Apr-15 20-Apr-15 12-May-15 26-May-15 0% 0% -28.00
DHSLBP3100Slab - Level P2 7.00 07-Apr-15 14-Apr-15 12-May-15 20-May-15 0% 0% -28.00
DHCLBP4100Columns & Walls 5.00 15-Apr-15 20-Apr-15 21-May-15 26-May-15 0% 0% -28.00
STAIRCASES LEVEL P2 16.00 30-Apr-14 05-May-14 12-Feb-14 A 05-May-14 A 0% 0%
DHSLAP5210 Stair # 3 6.00 30-Apr-14 30-Apr-14 12-Feb-14 A 17-Feb-14 A 100% 100%
DHSLAP5220 Stair # 1 4.00 01-May-14 05-May-14 01-May-14 A 05-May-14 A 100% 100%
DHSLAP5200 Stair # 2 5.00 30-Apr-14 05-May-14 30-Apr-14 A 05-May-14 A 100% 100%
LEVEL P3 (+9.30 FFL) 472.00 24-Feb-14 04-May-15 04-Nov-13 A 09-Jun-15 84.81% 84.81% -28.00
STRUCTURAL P3 472.00 24-Feb-14 04-May-15 04-Nov-13 A 09-Jun-15 84.81% 84.81% -28.00
LEVEL P3 (ZONE A) 32.00 24-Feb-14 24-Feb-14 04-Nov-13 A 31-Dec-13 A 100% 100%
LEVEL P3 (ZONE B) 12.00 21-Apr-15 04-May-15 27-May-15 09-Jun-15 0% 0% -28.00
DHSLBP4100Slab - Level P3 7.00 21-Apr-15 28-Apr-15 27-May-15 03-Jun-15 0% 0% -28.00
DHCLBP5100Columns & Walls 5.00 29-Apr-15 04-May-15 04-Jun-15 09-Jun-15 0% 0% -28.00
STAIRCASES LEVEL P3 6.00 06-May-14 12-May-14 06-May-14 A 12-May-14 A 0% 0%
DHSLAP5250 Stair # 1 4.00 07-May-14 11-May-14 07-May-14 A 11-May-14 A 100% 100%
DHSLAP5230 Stair # 2 5.00 06-May-14 11-May-14 06-May-14 A 11-May-14 A 100% 100%
DHSLAP5240 Stair # 3 6.00 06-May-14 12-May-14 06-May-14 A 12-May-14 A 100% 100%
LEVEL P4 (+12.4 FFL) 471.00 24-Feb-14 19-May-15 05-Dec-13 A 23-Jun-15 84.73% 84.73% -28.00
STRUCTURAL P4 471.00 24-Feb-14 19-May-15 05-Dec-13 A 23-Jun-15 84.73% 84.73% -28.00
LEVEL P4 (ZONE A) 34.00 24-Feb-14 24-Feb-14 05-Dec-13 A 21-Jan-14 A 100% 100%
LEVEL P4 (ZONE B) 12.00 05-May-15 19-May-15 10-Jun-15 23-Jun-15 0% 0% -28.00
DHSLBP5100Slab - Level P4 7.00 05-May-15 12-May-15 10-Jun-15 17-Jun-15 0% 0% -28.00
DHCLBP5110Columns & Walls 5.00 13-May-15 19-May-15 18-Jun-15 23-Jun-15 0% 0% -28.00
STAIRCASES LEVEL P4 7.00 12-May-14 19-May-14 12-May-14 A 19-May-14 A 0% 0%
DHSLAP5267 Stair # 1 4.00 13-May-14 17-May-14 13-May-14 A 17-May-14 A 100% 100%
DHSLAP5260 Stair # 2 5.00 12-May-14 17-May-14 12-May-14 A 17-May-14 A 100% 100%
DHSLAP5265 Stair # 3 6.00 13-May-14 19-May-14 13-May-14 A 19-May-14 A 100% 100%
LEVEL P5 (+15.79 FFL) 458.00 24-Feb-14 04-Jun-15 08-Jan-14 A 09-Jul-15 92.33% 92.33% -28.00
STRUCTURAL P5 458.00 24-Feb-14 04-Jun-15 08-Jan-14 A 09-Jul-15 92.33% 92.33% -28.00
LEVEL P5 (ZONE A) 35.00 24-Feb-14 25-Mar-14 08-Jan-14 A 24-Feb-14 A 100% 100%
LEVEL P5 (ZONE B) 14.00 20-May-15 04-Jun-15 24-Jun-15 09-Jul-15 0% 0% -28.00
2014 2015 2016 2017
Columns & Walls
Stair # 3
Stair # 2
Stair # 1
Slab - Level P1
Columns & Walls
Stair # 3
Stair # 1
Stair # 2
Slab - Level P2
Columns & Walls
Stair # 3
Stair # 1
Stair # 2
Slab - Level P3
Columns & Walls
Stair # 1
Stair # 2
Stair # 3
Slab - Level P4
Columns & Walls
Stair # 1
Stair # 2
Stair # 3
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 3 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
DAMAC Gulf Properties L.L.C
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
DHSLBP5130Slab - Level P5 14.00 20-May-15 04-Jun-15 24-Jun-15 09-Jul-15 0% 0% -28.00
STAIRCASES LEVEL P5 6.00 18-May-14 24-May-14 18-May-14 A 24-May-14 A 0% 0%
DHSLAP5290 Stair # 2 5.00 18-May-14 22-May-14 18-May-14 A 22-May-14 A 100% 100%
DHSLAP5299 Stair # 1 4.00 20-May-14 24-May-14 20-May-14 A 24-May-14 A 100% 100%
TOWER 454.00 24-Feb-14 12-Aug-15 10-Feb-14 A 17-Aug-15 45.41% 44.61% 7.00
LEVELS 06 - 29 207.00 24-Feb-14 23-Oct-14 10-Feb-14 A 27-Oct-14 100% 100% 50.00
LEVEL 06 83.00 24-Feb-14 29-May-14 10-Feb-14 A 18-May-14 A 100% 100%
STRUCTURAL - LEVEL 6 20.00 24-Feb-14 16-Mar-14 10-Feb-14 A 09-Mar-14 A 100% 100%
DHCWA07100Core Wal - Level 06 6.00 24-Feb-14 24-Feb-14 15-Feb-14 A 20-Feb-14 A 100% 100%
DHSLA06100Construction of Horizontals - L06 4.00 10-Mar-14 11-Mar-14 10-Feb-14 A 04-Mar-14 A 100% 100%
DHCWA07110Construction of Verticals - L06 3.00 13-Mar-14 16-Mar-14 06-Mar-14 A 09-Mar-14 A 100% 100%
STAIRCASES 4.00 25-May-14 29-May-14 08-May-14 A 18-May-14 A 0% 0%
DHSLA06102Stair # 2 4.00 25-May-14 29-May-14 08-May-14 A 13-May-14 A 100% 100%
DHSLA06104Stair # 1 4.00 25-May-14 29-May-14 13-May-14 A 18-May-14 A 100% 100%
LEVEL 07 83.00 24-Feb-14 05-Jun-14 20-Feb-14 A 24-May-14 A 100% 100%
STRUCTURAL - LEVEL 07 21.00 24-Feb-14 24-Mar-14 20-Feb-14 A 20-Mar-14 A 100% 100%
DHCWA08100Core Wal - Level 07 9.00 24-Feb-14 05-Mar-14 20-Feb-14 A 28-Feb-14 A 100% 100%
DHSLA07100Construction of Horizontals - L07 4.00 17-Mar-14 20-Mar-14 06-Mar-14 A 16-Mar-14 A 100% 100%
DHCWA08110Construction of Verticals - L07 3.00 22-Mar-14 24-Mar-14 16-Mar-14 A 20-Mar-14 A 100% 100%
STAIRCASES 4.00 02-Jun-14 05-Jun-14 17-May-14 A 24-May-14 A 0% 0%
A1330 Stair # 2 4.00 02-Jun-14 05-Jun-14 17-May-14 A 22-May-14 A 100% 100%
A1320 Stair # 1 4.00 02-Jun-14 05-Jun-14 18-May-14 A 24-May-14 A 100% 100%
LEVEL 08 83.00 06-Mar-14 11-Jun-14 01-Mar-14 A 31-May-14 A 100% 100%
STRUCTURAL WORKS - LEVEL 08 22.00 06-Mar-14 31-Mar-14 01-Mar-14 A 28-Mar-14 A 100% 100%
DHCWA09100Core Wal - Level 08 9.00 06-Mar-14 16-Mar-14 01-Mar-14 A 11-Mar-14 A 100% 100%
DHSLA08100Construction of Horizontals - L08 4.00 24-Mar-14 27-Mar-14 16-Mar-14 A 24-Mar-14 A 100% 100%
DHCWA09110Construction of Verticals - L08 3.00 29-Mar-14 31-Mar-14 25-Mar-14 A 28-Mar-14 A 100% 100%
STAIRCASES 4.00 08-Jun-14 11-Jun-14 22-May-14 A 31-May-14 A 0% 0%
A1350 Stair # 2 4.00 08-Jun-14 11-Jun-14 22-May-14 A 28-May-14 A 100% 100%
A1340 Stair # 1 4.00 08-Jun-14 11-Jun-14 25-May-14 A 31-May-14 A 100% 100%
LEVEL 09 79.00 17-Mar-14 17-Jun-14 12-Mar-14 A 23-Jun-14 A 100% 100%
STRUCTURAL WORKS -LEVEL 09 19.00 17-Mar-14 07-Apr-14 12-Mar-14 A 08-Apr-14 A 100% 100%
DHCWA10100Core Wall - Level 09 10.00 17-Mar-14 27-Mar-14 12-Mar-14 A 27-Mar-14 A 100% 100%
DHSLA09100Construction of Horizontals - L09 4.00 31-Mar-14 03-Apr-14 25-Mar-14 A 03-Apr-14 A 100% 100%
DHCWA10110Construction of Verticals - L09 3.00 05-Apr-14 07-Apr-14 03-Apr-14 A 08-Apr-14 A 100% 100%
STAIRCASES 4.00 14-Jun-14 17-Jun-14 19-Jun-14 A 23-Jun-14 A 0% 0%
A1360 Stair # 1 4.00 14-Jun-14 17-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100%
A1370 Stair # 2 4.00 14-Jun-14 17-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100%
LEVEL 10 74.00 29-Mar-14 23-Jun-14 29-Mar-14 A 23-Jun-14 A 100% 100%
STRUCTURAL WORKS -LEVEL 10 15.00 29-Mar-14 14-Apr-14 29-Mar-14 A 15-Apr-14 A 100% 100%
DHCWA11100Core Wall - Level 10 4.00 29-Mar-14 01-Apr-14 29-Mar-14 A 06-Apr-14 A 100% 100%
DHSLA10100Construction of Horizontals - L10 4.00 07-Apr-14 10-Apr-14 05-Apr-14 A 10-Apr-14 A 100% 100%
DHCWA11110Construction of Verticals - L10 3.00 12-Apr-14 14-Apr-14 13-Apr-14 A 15-Apr-14 A 100% 100%
STAIRCASES 4.00 19-Jun-14 23-Jun-14 19-Jun-14 A 23-Jun-14 A 0% 0%
A1380 Stair # 1 4.00 19-Jun-14 23-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100%
A1390 Stair # 2 4.00 19-Jun-14 23-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100%
LEVEL 11 75.00 02-Apr-14 29-Jun-14 07-Apr-14 A 23-Jun-14 A 100% 100%
STRUCTURAL WORKS -LEVEL 11 16.00 02-Apr-14 20-Apr-14 07-Apr-14 A 21-Apr-14 A 100% 100%
DHCWA12100Core Wall - Level 11 4.00 02-Apr-14 06-Apr-14 07-Apr-14 A 08-Apr-14 A 100% 100%
2014 2015 2016 2017
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
Slab - Level P5
Stair # 2
Stair # 1
Core Wal - Level 06
Construction of Horizontals - L06
Construction of Verticals - L06
Stair # 2
Stair # 1
Core Wal - Level 07
Construction of Horizontals - L07
Construction of Verticals - L07
Stair # 2
Stair # 1
Core Wal - Level 08
Construction of Horizontals - L08
Construction of Verticals - L08
Stair # 2
Stair # 1
Core Wall - Level 09
Construction of Horizontals - L09
Construction of Verticals - L09
Stair # 1
Stair # 2
Core Wall - Level 10
Construction of Horizontals - L10
Construction of Verticals - L10
Stair # 1
Stair # 2
Core Wall - Level 11
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 4 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
DHSLA11100Construction of Horizontals - L11 4.00 14-Apr-14 17-Apr-14 12-Apr-14 A 17-Apr-14 A 100% 100%
DHCWA12110Construction of Verticals - L11 2.00 19-Apr-14 20-Apr-14 18-Apr-14 A 21-Apr-14 A 100% 100%
STAIRCASES 4.00 25-Jun-14 29-Jun-14 19-Jun-14 A 23-Jun-14 A 0% 0%
A1400 Stair # 1 4.00 25-Jun-14 29-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100%
A1410 Stair # 2 4.00 25-Jun-14 29-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100%
LEVEL 12 144.00 07-Apr-14 07-Jul-14 06-Apr-14 A 23-Jun-14 A 100% 100%
STRUCTURAL WORKS -LEVEL 12 144.00 07-Apr-14 27-Apr-14 06-Apr-14 A 28-Apr-14 A 100% 100%
DHCWA13120Tower Crane Jump 1.00 13-Apr-14 13-Apr-14 06-Apr-14 A 06-Apr-14 A 100% 100%
DHCWA13100Core Wall - Level 12 6.00 07-Apr-14 13-Apr-14 10-Apr-14 A 14-Apr-14 A 100% 100%
DHSLA12100Construction of Horizontals - L12 4.00 21-Apr-14 24-Apr-14 19-Apr-14 A 24-Apr-14 A 100% 100%
DHCWA13110Construction of Verticals - L12 2.00 26-Apr-14 27-Apr-14 25-Apr-14 A 28-Apr-14 A 100% 100%
STAIRCASES 4.00 03-Jul-14 07-Jul-14 19-Jun-14 A 23-Jun-14 A 0% 0%
A1420 Stair # 1 4.00 03-Jul-14 07-Jul-14 19-Jun-14 A 23-Jun-14 A 100% 100%
A1430 Stair # 2 3.00 05-Jul-14 07-Jul-14 19-Jun-14 A 23-Jun-14 A 100% 100%
LEVEL 13 79.00 14-Apr-14 15-Jul-14 15-Apr-14 A 14-Jul-14 A 100% 100%
STRUCTURAL WORKS -LEVEL 13 17.00 14-Apr-14 03-May-14 15-Apr-14 A 05-May-14 A 100% 100%
DHCWA14100Core Wall - Level 13 4.00 14-Apr-14 17-Apr-14 15-Apr-14 A 20-Apr-14 A 100% 100%
DHSLA13100Construction of Horizontals - L13 3.00 28-Apr-14 30-Apr-14 25-Apr-14 A 01-May-14 A 100% 100%
DHCWA14110Construction of Verticals - L13 2.00 01-May-14 03-May-14 02-May-14 A 05-May-14 A 100% 100%
STAIRCASES 4.00 12-Jul-14 15-Jul-14 19-Jun-14 A 14-Jul-14 A 0% 0%
A1450 Stair # 2 3.00 13-Jul-14 15-Jul-14 19-Jun-14 A 23-Jun-14 A 100% 100%
A1440 Stair # 1 4.00 12-Jul-14 15-Jul-14 23-Jun-14 A 14-Jul-14 A 100% 100%
LEVEL 14 82.00 19-Apr-14 23-Jul-14 21-Apr-14 A 20-Jul-14 A 100% 100%
STRUCTURAL WORKS - LEVEL 14 18.00 19-Apr-14 08-May-14 21-Apr-14 A 11-May-14 A 100% 100%
DHCWA15100Core Wall - Level 14 4.00 19-Apr-14 22-Apr-14 21-Apr-14 A 27-Apr-14 A 100% 100%
DHSLA14100Construction of Horizontals - L14 3.00 04-May-14 06-May-14 03-May-14 A 08-May-14 A 100% 100%
DHCWA15110Construction of Verticals - L14 2.00 07-May-14 08-May-14 09-May-14 A 11-May-14 A 100% 100%
STAIRCASES 4.00 20-Jul-14 23-Jul-14 16-Jul-14 A 20-Jul-14 A 0% 0%
A1460 Stair # 1 4.00 20-Jul-14 23-Jul-14 16-Jul-14 A 20-Jul-14 A 100% 100%
A1470 Stair # 2 3.00 21-Jul-14 23-Jul-14 17-Jul-14 A 20-Jul-14 A 100% 100%
LEVEL 15 84.00 23-Apr-14 02-Aug-14 28-Apr-14 A 26-Jul-14 A 100% 100%
STRUCTURAL WORKS -LEVEL 15 19.00 23-Apr-14 14-May-14 28-Apr-14 A 18-May-14 A 100% 100%
DHCWA16100Core Wall - Level 15 9.00 23-Apr-14 03-May-14 28-Apr-14 A 05-May-14 A 100% 100%
DHSLA15100Construction of Horizontals - L15 3.00 10-May-14 12-May-14 10-May-14 A 15-May-14 A 100% 100%
DHCWA16110Construction of Verticals - L15 2.00 13-May-14 14-May-14 17-May-14 A 18-May-14 A 100% 100%
STAIRCASES 4.00 27-Jul-14 02-Aug-14 22-Jul-14 A 26-Jul-14 A 0% 0%
A1480 Stair # 1 4.00 27-Jul-14 02-Aug-14 22-Jul-14 A 26-Jul-14 A 100% 100%
A1490 Stair # 2 3.00 30-Jul-14 02-Aug-14 22-Jul-14 A 26-Jul-14 A 100% 100%
LEVEL 16 121.00 04-May-14 07-Aug-14 05-May-14 A 31-Jul-14 A 100% 100%
STRUCTURAL WORKS -LEVEL 16 121.00 04-May-14 20-May-14 05-May-14 A 23-May-14 A 100% 100%
DHCWA17120Tower Crane Jump 1.00 08-May-14 08-May-14 05-May-14 A 05-May-14 A 100% 100%
DHCWA17100Core Wall - Level 16 5.00 04-May-14 08-May-14 06-May-14 A 08-May-14 A 100% 100%
DHSLA16100Construction of Horizontals- L16 3.00 15-May-14 18-May-14 16-May-14 A 20-May-14 A 100% 100%
DHCWA17110Construction of Verticals - L16 2.00 19-May-14 20-May-14 21-May-14 A 23-May-14 A 100% 100%
STAIRCASES 4.00 04-Aug-14 07-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0%
A1500 Stair # 1 4.00 04-Aug-14 07-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100%
A1510 Stair # 2 3.00 05-Aug-14 07-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100%
LEVEL 17 80.00 10-May-14 13-Aug-14 10-May-14 A 31-Jul-14 A 100% 100%
STRUCTURAL WORKS - LEVEL 17 15.00 10-May-14 26-May-14 10-May-14 A 30-May-14 A 100% 100%
2014 2015 2016 2017
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
Construction of Horizontals - L11
Construction of Verticals - L11
Stair # 1
Stair # 2
Tower Crane Jump
Core Wall - Level 12
Construction of Horizontals - L12
Construction of Verticals - L12
Stair # 1
Stair # 2
Core Wall - Level 13
Construction of Horizontals - L13
Construction of Verticals - L13
Stair # 2
Stair # 1
Core Wall - Level 14
Construction of Horizontals - L14
Construction of Verticals - L14
Stair # 1
Stair # 2
Core Wall - Level 15
Construction of Horizontals - L15
Construction of Verticals - L15
Stair # 1
Stair # 2
Tower Crane Jump
Core Wall - Level 16
Construction of Horizontals- L16
Construction of Verticals - L16
Stair # 1
Stair # 2
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 5 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
DHCWA18100Core Wall - Level 17 5.00 10-May-14 14-May-14 10-May-14 A 14-May-14 A 100% 100%
DHSLA17100Construction of Horizontals - L17 3.00 21-May-14 24-May-14 21-May-14 A 27-May-14 A 100% 100%
DHCWA18110Construction of Verticals - L17 2.00 25-May-14 26-May-14 28-May-14 A 30-May-14 A 100% 100%
STAIRCASES 4.00 10-Aug-14 13-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0%
A1520 Stair # 1 4.00 10-Aug-14 13-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100%
A1530 Stair # 2 3.00 11-Aug-14 13-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100%
LEVEL 18 81.00 15-May-14 20-Aug-14 15-May-14 A 31-Jul-14 A 100% 100%
STRUCTURAL WORKS -LEVEL 18 16.00 15-May-14 03-Jun-14 15-May-14 A 05-Jun-14 A 100% 100%
DHCWA19100Core Wall - Level 18 5.00 15-May-14 20-May-14 15-May-14 A 19-May-14 A 100% 100%
DHSLA18100Construction of Horizontals - L18 3.00 29-May-14 01-Jun-14 28-May-14 A 03-Jun-14 A 100% 100%
DHCWA19110Construction of Verticals - L18 2.00 02-Jun-14 03-Jun-14 04-Jun-14 A 05-Jun-14 A 100% 100%
STAIRCASES 4.00 17-Aug-14 20-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0%
A1540 Stair # 1 4.00 17-Aug-14 20-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100%
A1550 Stair # 2 3.00 18-Aug-14 20-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100%
LEVEL 19 106.00 21-May-14 27-Aug-14 20-May-14 A 31-Jul-14 A 100% 100%
STRUCTURAL WORKS -LEVEL 19 106.00 21-May-14 09-Jun-14 20-May-14 A 12-Jun-14 A 100% 100%
DHCWA20120Tower Crane Jump 1.00 26-May-14 26-May-14 20-May-14 A 20-May-14 A 100% 100%
DHCWA20100Core Wall - Level 19 5.00 21-May-14 26-May-14 20-May-14 A 26-May-14 A 100% 100%
DHSLA191000Construction of Horizontals - L19 3.00 04-Jun-14 07-Jun-14 04-Jun-14 A 09-Jun-14 A 100% 100%
DHCWA20110Construction of Verticals - L19 2.00 08-Jun-14 09-Jun-14 10-Jun-14 A 12-Jun-14 A 100% 100%
STAIRCASES 4.00 24-Aug-14 27-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0%
A1560 Stair # 1 4.00 24-Aug-14 27-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100%
A1570 Stair # 2 3.00 25-Aug-14 27-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100%
LEVEL 20 84.00 28-May-14 04-Sep-14 27-May-14 A 06-Aug-14 A 100% 100%
STRUCTURAL WORKS - LEVEL 20 16.00 28-May-14 15-Jun-14 27-May-14 A 18-Jun-14 A 100% 100%
DHCWA21100Core Wall - Level 20 4.00 28-May-14 01-Jun-14 27-May-14 A 31-May-14 A 100% 100%
DHSLA20100Construction of Horizontals - L20 3.00 10-Jun-14 12-Jun-14 11-Jun-14 A 14-Jun-14 A 100% 100%
DHCWA21110Construction of Verticals - L20 2.00 14-Jun-14 15-Jun-14 15-Jun-14 A 18-Jun-14 A 100% 100%
STAIRCASES 4.00 01-Sep-14 04-Sep-14 02-Aug-14 A 06-Aug-14 A 0% 0%
A1580 Stair # 1 4.00 01-Sep-14 04-Sep-14 02-Aug-14 A 06-Aug-14 A 100% 100%
A1590 Stair # 2 3.00 02-Sep-14 04-Sep-14 02-Aug-14 A 06-Aug-14 A 100% 100%
LEVEL 21 85.00 02-Jun-14 10-Sep-14 01-Jun-14 A 12-Aug-14 A 100% 100%
STRUCTURAL WORKS - LEVEL 21 17.00 02-Jun-14 21-Jun-14 01-Jun-14 A 24-Jun-14 A 100% 100%
DHCWA22100Core Wall - Level 21 4.00 02-Jun-14 05-Jun-14 01-Jun-14 A 06-Jun-14 A 100% 100%
DHSLA21100Construction of Horizontals - L21 3.00 16-Jun-14 18-Jun-14 18-Jun-14 A 21-Jun-14 A 100% 100%
DHCWA22110Construction of Verticals - L21 2.00 19-Jun-14 21-Jun-14 22-Jun-14 A 24-Jun-14 A 100% 100%
STAIRCASES 4.00 07-Sep-14 10-Sep-14 07-Aug-14 A 12-Aug-14 A 0% 0%
A1600 Stair # 1 4.00 07-Sep-14 10-Sep-14 07-Aug-14 A 12-Aug-14 A 100% 100%
A1610 Stair # 2 3.00 08-Sep-14 10-Sep-14 07-Aug-14 A 12-Aug-14 A 100% 100%
LEVEL 22 81.00 12-Jun-14 16-Sep-14 07-Jun-14 A 26-Aug-14 A 100% 100%
STRUCTURAL WORKS - LEVEL 22 13.00 12-Jun-14 26-Jun-14 07-Jun-14 A 30-Jun-14 A 100% 100%
DHCWA23100Core Wall - Level 22 4.00 12-Jun-14 16-Jun-14 07-Jun-14 A 10-Jun-14 A 100% 100%
DHSLA22100Construction of Horizontals - L22 3.00 22-Jun-14 24-Jun-14 24-Jun-14 A 27-Jun-14 A 100% 100%
DHCWA23110Construction of Verticals - L22 2.00 25-Jun-14 26-Jun-14 28-Jun-14 A 30-Jun-14 A 100% 100%
STAIRCASES 4.00 13-Sep-14 16-Sep-14 13-Aug-14 A 26-Aug-14 A 0% 0%
A1620 Stair # 1 4.00 13-Sep-14 16-Sep-14 13-Aug-14 A 18-Aug-14 A 100% 100%
A1630 Stair # 2 3.00 14-Sep-14 16-Sep-14 23-Aug-14 A 26-Aug-14 A 100% 100%
LEVEL 23 84.00 17-Jun-14 21-Sep-14 12-Jun-14 A 23-Aug-14 A 100% 100%
STRUCTURAL WORKS - LEVEL 23 84.00 17-Jun-14 06-Jul-14 12-Jun-14 A 08-Jul-14 A 100% 100%
2014 2015 2016 2017
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
Core Wall - Level 17
Construction of Horizontals - L17
Construction of Verticals - L17
Stair # 1
Stair # 2
Core Wall - Level 18
Construction of Horizontals - L18
Construction of Verticals - L18
Stair # 1
Stair # 2
Tower Crane Jump
Core Wall - Level 19
Construction of Horizontals - L19
Construction of Verticals - L19
Stair # 1
Stair # 2
Core Wall - Level 20
Construction of Horizontals - L20
Construction of Verticals - L20
Stair # 1
Stair # 2
Core Wall - Level 21
Construction of Horizontals - L21
Construction of Verticals - L21
Stair # 1
Stair # 2
Core Wall - Level 22
Construction of Horizontals - L22
Construction of Verticals - L22
Stair # 1
Stair # 2
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 6 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
DHCWA24100Core Wall - Level 23 4.00 17-Jun-14 21-Jun-14 12-Jun-14 A 15-Jun-14 A 100% 100%
DHCWA24120Tower Crane Jump 1.00 21-Jun-14 21-Jun-14 17-Jun-14 A 17-Jun-14 A 100% 100%
DHSLA23100Construction of Horizontals- L23 5.00 28-Jun-14 02-Jul-14 27-Jun-14 A 04-Jul-14 A 100% 100%
DHCWA24110Construction of Verticals - L23 3.00 03-Jul-14 06-Jul-14 04-Jul-14 A 08-Jul-14 A 100% 100%
STAIRCASES 4.00 17-Sep-14 21-Sep-14 18-Aug-14 A 23-Aug-14 A 0% 0%
A1640 Stair # 1 4.00 17-Sep-14 21-Sep-14 18-Aug-14 A 23-Aug-14 A 100% 100%
A1650 Stair # 2 3.00 18-Sep-14 21-Sep-14 18-Aug-14 A 23-Aug-14 A 100% 100%
LEVEL 24 81.00 22-Jun-14 25-Sep-14 17-Jun-14 A 30-Aug-14 A 100% 100%
STRUCTURAL WORKS - LEVEL 24 20.00 22-Jun-14 14-Jul-14 17-Jun-14 A 14-Jul-14 A 100% 100%
DHCWA25100Core Wall - Level 24 8.00 22-Jun-14 30-Jun-14 17-Jun-14 A 19-Jun-14 A 100% 100%
DHSLA24100Construction of Horizontals - L24 4.00 07-Jul-14 10-Jul-14 04-Jul-14 A 10-Jul-14 A 100% 100%
DHCWA25110Construction of Verticals - L24 3.00 12-Jul-14 14-Jul-14 10-Jul-14 A 14-Jul-14 A 100% 100%
STAIRCASES 4.00 22-Sep-14 25-Sep-14 24-Aug-14 A 30-Aug-14 A 0% 0%
A1660 Stair # 1 4.00 22-Sep-14 25-Sep-14 24-Aug-14 A 30-Aug-14 A 100% 100%
A1670 Stair # 2 3.00 23-Sep-14 25-Sep-14 24-Aug-14 A 30-Aug-14 A 100% 100%
LEVEL 25 78.00 01-Jul-14 01-Oct-14 21-Jun-14 A 04-Sep-14 A 100% 100%
STRUCTURAL WORKS - LEVEL 25 18.00 01-Jul-14 21-Jul-14 21-Jun-14 A 19-Jul-14 A 100% 100%
DHCWA26100Core Wall - Level 25 5.00 01-Jul-14 06-Jul-14 21-Jun-14 A 26-Jun-14 A 100% 100%
DHSLA25100Construction of Horizontals - L25 4.00 15-Jul-14 19-Jul-14 10-Jul-14 A 17-Jul-14 A 100% 100%
DHCWA26110Construction of Verticals - L25 2.00 20-Jul-14 21-Jul-14 17-Jul-14 A 19-Jul-14 A 100% 100%
STAIRCASES 4.00 28-Sep-14 01-Oct-14 01-Sep-14 A 04-Sep-14 A 0% 0%
A1680 Stair # 1 4.00 28-Sep-14 01-Oct-14 01-Sep-14 A 04-Sep-14 A 75% 100%
A1690 Stair # 2 3.00 29-Sep-14 01-Oct-14 01-Sep-14 A 04-Sep-14 A 66.67% 100%
LEVEL 26 78.00 07-Jul-14 09-Oct-14 27-Jun-14 A 08-Sep-14 A 100% 100%
STRUCTURAL WORKS - LEVEL 26 19.00 07-Jul-14 30-Jul-14 27-Jun-14 A 26-Jul-14 A 100% 100%
DHCWA27100Core Wall - Level 26 6.00 07-Jul-14 13-Jul-14 27-Jun-14 A 03-Jul-14 A 100% 100%
DHSLA26100Construction of Horizontals - L26 4.00 22-Jul-14 26-Jul-14 17-Jul-14 A 23-Jul-14 A 100% 100%
DHCWA27110Construction of Verticals - L26 2.00 27-Jul-14 30-Jul-14 22-Jul-14 A 26-Jul-14 A 100% 100%
STAIRCASES 4.00 06-Oct-14 09-Oct-14 05-Sep-14 A 08-Sep-14 A 0% 0%
A1700 Stair # 1 4.00 06-Oct-14 09-Oct-14 05-Sep-14 A 08-Sep-14 A 0% 100%
A1710 Stair # 2 3.00 07-Oct-14 09-Oct-14 05-Sep-14 A 08-Sep-14 A 0% 100%
LEVEL 27 76.00 14-Jul-14 14-Oct-14 04-Jul-14 A 14-Sep-14 A 100% 100%
STRUCTURAL WORKS - LEVEL 27 61.00 14-Jul-14 05-Aug-14 04-Jul-14 A 05-Aug-14 A 100% 100%
DHCWA28100Core Wall - L27 6.00 14-Jul-14 20-Jul-14 04-Jul-14 A 14-Jul-14 A 100% 100%
DHCWA28120Tower Crane Jump 1.00 20-Jul-14 20-Jul-14 15-Jul-14 A 17-Jul-14 A 100% 100%
DHSLA27100Construction of Horizontals - L27 3.00 31-Jul-14 03-Aug-14 27-Jul-14 A 31-Jul-14 A 100% 100%
DHCWA28110Construction of Verticals - L27 2.00 04-Aug-14 05-Aug-14 04-Aug-14 A 05-Aug-14 A 100% 100%
STAIRCASES 4.00 11-Oct-14 14-Oct-14 09-Sep-14 A 14-Sep-14 A 0% 0%
A1720 Stair # 1 4.00 11-Oct-14 14-Oct-14 09-Sep-14 A 14-Sep-14 A 0% 100%
A1730 Stair # 2 3.00 11-Oct-14 13-Oct-14 09-Sep-14 A 14-Sep-14 A 0% 100%
LEVEL 28 76.00 21-Jul-14 19-Oct-14 15-Jul-14 A 21-Oct-14 100% 100% 50.00
STRUCTURAL WORKS - LEVEL 28 18.00 21-Jul-14 12-Aug-14 15-Jul-14 A 11-Aug-14 A 100% 100%
DHCWA29100Core Wall - L28 6.00 21-Jul-14 27-Jul-14 15-Jul-14 A 21-Jul-14 A 100% 100%
DHSLA28100Construction of Horizontals - L28 3.00 06-Aug-14 09-Aug-14 06-Aug-14 A 09-Aug-14 A 100% 100%
DHCWA29110Construction of Verticals - L28 3.00 10-Aug-14 12-Aug-14 10-Aug-14 A 11-Aug-14 A 100% 100%
STAIRCASES 4.00 15-Oct-14 19-Oct-14 18-Oct-14 21-Oct-14 0% 0% 50.00
A1740 Stair # 1 4.00 15-Oct-14 19-Oct-14 18-Oct-14 21-Oct-14 0% 0% 13.00
A1750 Stair # 2 3.00 15-Oct-14 18-Oct-14 19-Oct-14 21-Oct-14 0% 0% 50.00
2014 2015 2016 2017
Core Wall - Level 23
Tower Crane Jump
Construction of Horizontals- L23
Construction of Verticals - L23
Stair # 1
Stair # 2
Core Wall - Level 24
Construction of Horizontals - L24
Construction of Verticals - L24
Stair # 1
Stair # 2
Core Wall - Level 25
Construction of Horizontals - L25
Construction of Verticals - L25
Stair # 1
Stair # 2
Core Wall - Level 26
Construction of Horizontals - L26
Construction of Verticals - L26
Stair # 1
Stair # 2
Core Wall - L27
Tower Crane Jump
Construction of Horizontals - L27
Construction of Verticals - L27
Stair # 1
Stair # 2
Core Wall - L28
Construction of Horizontals - L28
Construction of Verticals - L28
Stair # 1
Stair # 2
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 7 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
LEVEL 29 74.00 30-Jul-14 23-Oct-14 22-Jul-14 A 27-Oct-14 100% 100% 50.00
STRUCTURAL WORKS - LEVEL 29 18.00 30-Jul-14 19-Aug-14 22-Jul-14 A 16-Aug-14 A 100% 100%
DHCWA30100Core Wall - L29 5.00 30-Jul-14 04-Aug-14 22-Jul-14 A 27-Jul-14 A 100% 100%
DHSLA29100Construction of Horizontals - L29 3.00 13-Aug-14 16-Aug-14 12-Aug-14 A 14-Aug-14 A 100% 100%
DHCWA30110Construction of Verticals - L29 3.00 17-Aug-14 19-Aug-14 15-Aug-14 A 16-Aug-14 A 100% 100%
STAIRCASES 4.00 19-Oct-14 23-Oct-14 22-Oct-14 27-Oct-14 0% 0% 50.00
A1760 Stair # 1 4.00 20-Oct-14 23-Oct-14 22-Oct-14 27-Oct-14 0% 0% 13.00
A1770 Stair # 2 4.00 19-Oct-14 22-Oct-14 22-Oct-14 27-Oct-14 0% 0% 50.00
LEVELS 30 (MECHANICAL FLOOR) 74.00 05-Aug-14 29-Oct-14 28-Jul-14 A 02-Nov-14 100% 100% 49.00
LEVEL 30 (MECHANICAL FLOOR) 74.00 05-Aug-14 29-Oct-14 28-Jul-14 A 02-Nov-14 100% 100% 49.00
STRUCTURAL WORKS - LEVEL 30 45.00 05-Aug-14 26-Aug-14 28-Jul-14 A 28-Aug-14 A 100% 100%
DHCWA31100Core Wall - L30 6.00 05-Aug-14 11-Aug-14 28-Jul-14 A 13-Aug-14 A 100% 100%
DHCWA31120Tower Crane Jump 1.00 05-Aug-14 05-Aug-14 20-Aug-14 A 20-Aug-14 A 100% 100%
DHSLA30100Construction of Horizontals - L30 (Mech Floor) 3.00 20-Aug-14 23-Aug-14 17-Aug-14 A 22-Aug-14 A 100% 100%
DHCWA31110Construction of Verticals - L30 (Mech Floor) 3.00 24-Aug-14 26-Aug-14 23-Aug-14 A 28-Aug-14 A 100% 100%
STAIRCASES 4.00 26-Oct-14 29-Oct-14 29-Oct-14 02-Nov-14 0% 0% 49.00
A1780 Stair # 1 4.00 26-Oct-14 29-Oct-14 29-Oct-14 02-Nov-14 0% 0% 12.00
A1790 Stair # 2 4.00 26-Oct-14 29-Oct-14 29-Oct-14 02-Nov-14 0% 0% 49.00
LEVELS 31 - 61 197.00 12-Aug-14 30-Mar-15 14-Aug-14 A 04-Apr-15 22.1% 20.3% 35.00
LEVEL 31 73.00 12-Aug-14 03-Nov-14 14-Aug-14 A 08-Nov-14 100% 100% 47.00
STRUCTURAL WORKS - LEVEL 31 19.00 12-Aug-14 02-Sep-14 14-Aug-14 A 02-Sep-14 A 100% 100%
DHCWA32100Core Wall - L31 6.00 12-Aug-14 18-Aug-14 14-Aug-14 A 17-Aug-14 A 100% 100%
DHSLA31100Construction of Horizontals - L31 4.00 27-Aug-14 31-Aug-14 29-Aug-14 A 31-Aug-14 A 100% 100%
DHCWA32110Construction of Verticals - L31 2.00 01-Sep-14 02-Sep-14 31-Aug-14 A 02-Sep-14 A 100% 100%
STAIRCASES 4.00 30-Oct-14 03-Nov-14 04-Nov-14 08-Nov-14 0% 0% 47.00
A1800 Stair # 1 4.00 30-Oct-14 03-Nov-14 04-Nov-14 08-Nov-14 0% 0% 11.00
A1810 Stair # 2 3.00 01-Nov-14 03-Nov-14 05-Nov-14 08-Nov-14 0% 0% 47.00
LEVEL 32 72.00 19-Aug-14 09-Nov-14 19-Aug-14 A 13-Nov-14 100% 100% 45.00
STRUCTURAL WORKS - LEVEL 32 18.00 19-Aug-14 08-Sep-14 19-Aug-14 A 09-Sep-14 A 100% 100%
DHCWA33100Core Wall - L32 4.00 19-Aug-14 23-Aug-14 19-Aug-14 A 24-Aug-14 A 100% 100%
DHSLA32100Construction of Horizontals - L32 4.00 02-Sep-14 06-Sep-14 02-Sep-14 A 07-Sep-14 A 100% 100%
DHCWA33110Construction of Verticals - L32 2.00 07-Sep-14 08-Sep-14 08-Sep-14 A 09-Sep-14 A 100% 100%
STAIRCASES 4.00 05-Nov-14 09-Nov-14 10-Nov-14 13-Nov-14 0% 0% 45.00
A1820 Stair # 1 4.00 05-Nov-14 09-Nov-14 10-Nov-14 13-Nov-14 0% 0% 10.00
A1830 Stair # 2 3.00 06-Nov-14 09-Nov-14 11-Nov-14 13-Nov-14 0% 0% 45.00
LEVEL 33 72.00 24-Aug-14 13-Nov-14 24-Aug-14 A 18-Nov-14 100% 100% 44.00
STRUCTURAL WORKS - LEVEL 33 19.00 24-Aug-14 14-Sep-14 24-Aug-14 A 14-Sep-14 A 100% 100%
DHCWA34100Core Wall - L33 5.00 24-Aug-14 28-Aug-14 24-Aug-14 A 28-Aug-14 A 100% 100%
DHSLA33100Construction of Horizontals - L33 4.00 08-Sep-14 11-Sep-14 10-Sep-14 A 12-Sep-14 A 100% 100%
DHCWA34110Construction of Verticals - L33 2.00 13-Sep-14 14-Sep-14 13-Sep-14 A 14-Sep-14 A 100% 100%
STAIRCASES 4.00 10-Nov-14 13-Nov-14 15-Nov-14 18-Nov-14 0% 0% 44.00
A1840 Stair # 1 4.00 10-Nov-14 13-Nov-14 15-Nov-14 18-Nov-14 0% 0% 10.00
A1850 Stair # 2 3.00 11-Nov-14 13-Nov-14 16-Nov-14 18-Nov-14 0% 0% 44.00
LEVEL 34 72.00 30-Aug-14 19-Nov-14 30-Aug-14 A 24-Nov-14 100% 100% 42.00
STRUCTURAL WORKS - LEVEL 34 25.00 30-Aug-14 18-Sep-14 30-Aug-14 A 21-Sep-14 A 100% 100%
DHCWA35100Core Wall - L34 5.00 30-Aug-14 03-Sep-14 30-Aug-14 A 03-Sep-14 A 100% 100%
DHCWA35120Tower Crane Jump 1.00 30-Aug-14 30-Aug-14 06-Sep-14 A 07-Sep-14 A 100% 100%
DHSLA34100Construction of Horizontals - L34 4.00 13-Sep-14 16-Sep-14 15-Sep-14 A 18-Sep-14 A 100% 100%
DHCWA35110Construction of Verticals - L34 2.00 17-Sep-14 18-Sep-14 20-Sep-14 A 21-Sep-14 A 100% 100%
2014 2015 2016 2017
Core Wall - L29
Construction of Horizontals - L29
Construction of Verticals - L29
Stair # 1
Stair # 2
Core Wall - L30
Tower Crane Jump
Construction of Horizontals - L30 (Mech Floor)
Construction of Verticals - L30 (Mech Floor)
Stair # 1
Stair # 2
Core Wall - L31
Construction of Horizontals - L31
Construction of Verticals - L31
Stair # 1
Stair # 2
Core Wall - L32
Construction of Horizontals - L32
Construction of Verticals - L32
Stair # 1
Stair # 2
Core Wall - L33
Construction of Horizontals - L33
Construction of Verticals - L33
Stair # 1
Stair # 2
Core Wall - L34
Tower Crane Jump
Construction of Horizontals - L34
Construction of Verticals - L34
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 8 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
STAIRCASES 4.00 16-Nov-14 19-Nov-14 20-Nov-14 24-Nov-14 0% 0% 42.00
A1860 Stair # 1 4.00 16-Nov-14 19-Nov-14 20-Nov-14 24-Nov-14 0% 0% 9.00
A1870 Stair # 2 3.00 17-Nov-14 19-Nov-14 22-Nov-14 24-Nov-14 0% 0% 42.00
LEVEL 35 72.00 04-Sep-14 25-Nov-14 04-Sep-14 A 30-Nov-14 100% 100% 41.00
STRUCTURAL WORKS - LEVEL 35 21.00 04-Sep-14 23-Sep-14 04-Sep-14 A 27-Sep-14 A 100% 100%
DHCWA36100Core Wall - L35 4.00 04-Sep-14 08-Sep-14 04-Sep-14 A 14-Sep-14 A 100% 100%
DHSLA35100Construction of Horizontals - L35 4.00 17-Sep-14 21-Sep-14 22-Sep-14 A 24-Sep-14 A 100% 100%
DHCWA36110Construction of Verticals - L35 2.00 22-Sep-14 23-Sep-14 25-Sep-14 A 27-Sep-14 A 100% 100%
STAIRCASES 4.00 22-Nov-14 25-Nov-14 26-Nov-14 30-Nov-14 0% 0% 41.00
A1880 Stair # 1 4.00 22-Nov-14 25-Nov-14 26-Nov-14 30-Nov-14 0% 0% 8.00
A1890 Stair # 2 4.00 22-Nov-14 25-Nov-14 26-Nov-14 30-Nov-14 0% 0% 41.00
LEVEL 36 72.00 09-Sep-14 30-Nov-14 15-Sep-14 A 06-Dec-14 100% 86.19% 41.00
STRUCTURAL WORKS - LEVEL 36 21.00 09-Sep-14 29-Sep-14 15-Sep-14 A 01-Oct-14 100% 86.19% -1.00
DHCWA37100Core Wall - L36 7.00 09-Sep-14 16-Sep-14 15-Sep-14 A 17-Sep-14 A 100% 100%
DHSLA36100Construction of Horizontals - L36 4.00 23-Sep-14 27-Sep-14 28-Sep-14 A 30-Sep-14 A 100% 100%
DHCWA37110Construction of Verticals - L36 2.00 28-Sep-14 29-Sep-14 30-Sep-14 A 01-Oct-14 100% 50% -1.00
STAIRCASES 4.00 26-Nov-14 30-Nov-14 01-Dec-14 06-Dec-14 0% 0% 41.00
A1900 Stair # 1 4.00 26-Nov-14 30-Nov-14 01-Dec-14 06-Dec-14 0% 0% 8.00
A1910 Stair # 2 4.00 26-Nov-14 30-Nov-14 01-Dec-14 06-Dec-14 0% 0% 41.00
LEVEL 37 64.00 17-Sep-14 06-Dec-14 18-Sep-14 A 10-Dec-14 48.36% 24.34% 41.00
STRUCTURAL WORKS - LEVEL 37 14.00 17-Sep-14 07-Oct-14 18-Sep-14 A 11-Oct-14 48.36% 24.34% -2.00
DHCWA38100Core Wall - L37 5.00 17-Sep-14 22-Sep-14 18-Sep-14 A 25-Sep-14 A 100% 100%
DHCWA38120Tower Crane Jump 1.00 17-Sep-14 17-Sep-14 01-Oct-14 01-Oct-14 100% 0% -4.00
DHSLA37100Construction of Horizontals - L37 4.00 29-Sep-14 02-Oct-14 02-Oct-14 08-Oct-14 50% 0% -2.00
DHCWA38110Construction of Verticals - L37 2.00 06-Oct-14 07-Oct-14 09-Oct-14 11-Oct-14 0% 0% -2.00
STAIRCASES 4.00 01-Dec-14 06-Dec-14 07-Dec-14 10-Dec-14 0% 0% 41.00
A1920 Stair # 1 4.00 01-Dec-14 06-Dec-14 07-Dec-14 10-Dec-14 0% 0% 8.00
A1930 Stair # 2 4.00 01-Dec-14 06-Dec-14 07-Dec-14 10-Dec-14 0% 0% 41.00
LEVEL 38 66.00 23-Sep-14 10-Dec-14 27-Sep-14 A 15-Dec-14 24.38% 24.38% 41.00
STRUCTURAL WORKS - LEVEL 38 15.00 23-Sep-14 11-Oct-14 27-Sep-14 A 14-Oct-14 24.38% 24.38% -2.00
DHCWA39100Core Wall - L38 4.00 23-Sep-14 27-Sep-14 27-Sep-14 A 29-Sep-14 A 100% 100%
DHSLA38100Construction of Horizontals - L38 3.00 06-Oct-14 08-Oct-14 09-Oct-14 12-Oct-14 0% 0% -2.00
DHCWA39110Construction of Verticals - L38 2.00 09-Oct-14 11-Oct-14 13-Oct-14 14-Oct-14 0% 0% -2.00
STAIRCASES 4.00 07-Dec-14 10-Dec-14 11-Dec-14 15-Dec-14 0% 0% 41.00
A1940 Stair # 1 4.00 07-Dec-14 10-Dec-14 11-Dec-14 15-Dec-14 0% 0% 8.00
A1950 Stair # 2 4.00 07-Dec-14 10-Dec-14 11-Dec-14 15-Dec-14 0% 0% 41.00
LEVEL 39 66.00 28-Sep-14 15-Dec-14 30-Sep-14 A 20-Dec-14 18.25% 0% 41.00
STRUCTURAL WORKS - LEVEL 39 15.00 28-Sep-14 15-Oct-14 30-Sep-14 A 19-Oct-14 18.25% 0% -2.00
DHCWA40100Core Wall - L39 4.00 28-Sep-14 01-Oct-14 30-Sep-14 A 08-Oct-14 75% 0% -4.00
DHSLA39100Construction of Horizontals - L39 4.00 09-Oct-14 13-Oct-14 13-Oct-14 16-Oct-14 0% 0% -2.00
DHCWA40110Construction of Verticals - L39 2.00 14-Oct-14 15-Oct-14 18-Oct-14 19-Oct-14 0% 0% -2.00
STAIRCASES 4.00 11-Dec-14 15-Dec-14 16-Dec-14 20-Dec-14 0% 0% 41.00
A1960 Stair # 1 4.00 11-Dec-14 15-Dec-14 16-Dec-14 20-Dec-14 0% 0% 8.00
A1970 Stair # 2 4.00 11-Dec-14 15-Dec-14 16-Dec-14 20-Dec-14 0% 0% 41.00
LEVEL 40 64.00 02-Oct-14 20-Dec-14 09-Oct-14 24-Dec-14 0% 0% 40.00
STRUCTURAL WORKS - LEVEL 40 13.00 02-Oct-14 20-Oct-14 09-Oct-14 23-Oct-14 0% 0% -2.00
DHCWA41100Core Wall - L40 4.00 02-Oct-14 08-Oct-14 09-Oct-14 13-Oct-14 0% 0% -4.00
DHSLA40100Construction of Horizontals - L40 4.00 14-Oct-14 18-Oct-14 18-Oct-14 21-Oct-14 0% 0% -2.00
DHCWA41110Construction of Verticals - L40 2.00 19-Oct-14 20-Oct-14 22-Oct-14 23-Oct-14 0% 0% -2.00
2014 2015 2016 2017
Stair # 1
Stair # 2
Core Wall - L35
Construction of Horizontals - L35
Construction of Verticals - L35
Stair # 1
Stair # 2
Core Wall - L36
Construction of Horizontals - L36
Construction of Verticals - L36
Stair # 1
Stair # 2
Core Wall - L37
Tower Crane Jump
Construction of Horizontals - L37
Construction of Verticals - L37
Stair # 1
Stair # 2
Core Wall - L38
Construction of Horizontals - L38
Construction of Verticals - L38
Stair # 1
Stair # 2
Core Wall - L39
Construction of Horizontals - L39
Construction of Verticals - L39
Stair # 1
Stair # 2
Core Wall - L40
Construction of Horizontals - L40
Construction of Verticals - L40
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 9 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
STAIRCASES 4.00 16-Dec-14 20-Dec-14 21-Dec-14 24-Dec-14 0% 0% 40.00
A1990 Stair # 2 3.00 16-Dec-14 18-Dec-14 21-Dec-14 23-Dec-14 0% 0% 41.00
A1980 Stair # 1 4.00 16-Dec-14 20-Dec-14 21-Dec-14 24-Dec-14 0% 0% 8.00
LEVEL 41 64.00 09-Oct-14 24-Dec-14 14-Oct-14 29-Dec-14 0% 0% 40.00
STRUCTURAL WORKS - LEVEL 41 14.00 09-Oct-14 27-Oct-14 14-Oct-14 30-Oct-14 0% 0% -2.00
DHCWA42120Tower Crane Jump 1.00 09-Oct-14 09-Oct-14 14-Oct-14 14-Oct-14 0% 0% -1.00
DHCWA42100Core Wall - L41 4.00 09-Oct-14 13-Oct-14 14-Oct-14 18-Oct-14 0% 0% -4.00
DHSLA41100Construction of Horizontals - L41 4.00 20-Oct-14 23-Oct-14 23-Oct-14 28-Oct-14 0% 0% -2.00
DHCWA42110Construction of Verticals - L41 2.00 26-Oct-14 27-Oct-14 29-Oct-14 30-Oct-14 0% 0% -2.00
STAIRCASES 5.00 20-Dec-14 24-Dec-14 24-Dec-14 29-Dec-14 0% 0% 40.00
A2010 Stair # 2 4.00 20-Dec-14 23-Dec-14 24-Dec-14 28-Dec-14 0% 0% 41.00
A2000 Stair # 1 4.00 21-Dec-14 24-Dec-14 25-Dec-14 29-Dec-14 0% 0% 8.00
LEVEL 42 64.00 14-Oct-14 29-Dec-14 19-Oct-14 04-Jan-15 0% 0% 40.00
STRUCTURAL WORKS - LEVEL 42 15.00 14-Oct-14 01-Nov-14 19-Oct-14 05-Nov-14 0% 0% -4.00
DHCWA43100Core Wall - L42 5.00 14-Oct-14 19-Oct-14 19-Oct-14 23-Oct-14 0% 0% -4.00
DHSLA42100Construction of Horizontals - L42 4.00 26-Oct-14 29-Oct-14 30-Oct-14 03-Nov-14 0% 0% -4.00
DHCWA43110Construction of Verticals - L42 2.00 30-Oct-14 01-Nov-14 04-Nov-14 05-Nov-14 0% 0% -4.00
STAIRCASES 5.00 24-Dec-14 29-Dec-14 29-Dec-14 04-Jan-15 0% 0% 40.00
A2030 Stair # 2 4.00 24-Dec-14 28-Dec-14 29-Dec-14 03-Jan-15 0% 0% 41.00
A2020 Stair # 1 4.00 25-Dec-14 29-Dec-14 30-Dec-14 04-Jan-15 0% 0% 8.00
LEVEL 43 63.00 20-Oct-14 04-Jan-15 26-Oct-14 08-Jan-15 0% 0% 40.00
STRUCTURAL WORKS - LEVEL 43 15.00 20-Oct-14 06-Nov-14 26-Oct-14 11-Nov-14 0% 0% -4.00
DHCWA44100Core Wall - L43 4.00 20-Oct-14 23-Oct-14 26-Oct-14 29-Oct-14 0% 0% -4.00
DHSLA43100Construction of Horizontals - L43 4.00 01-Nov-14 04-Nov-14 05-Nov-14 09-Nov-14 0% 0% -4.00
DHCWA44110Construction of Verticals - L43 2.00 05-Nov-14 06-Nov-14 10-Nov-14 11-Nov-14 0% 0% -4.00
STAIRCASES 5.00 29-Dec-14 04-Jan-15 04-Jan-15 08-Jan-15 0% 0% 40.00
A2050 Stair # 2 4.00 29-Dec-14 03-Jan-15 04-Jan-15 07-Jan-15 0% 0% 41.00
A2040 Stair # 1 4.00 30-Dec-14 04-Jan-15 05-Jan-15 08-Jan-15 0% 0% 8.00
LEVEL 44 63.00 26-Oct-14 08-Jan-15 30-Oct-14 13-Jan-15 0% 0% 40.00
STRUCTURAL WORKS - LEVEL 44 15.00 26-Oct-14 11-Nov-14 30-Oct-14 16-Nov-14 0% 0% -4.00
DHCWA45100Core Wall - L44 4.00 26-Oct-14 29-Oct-14 30-Oct-14 03-Nov-14 0% 0% -4.00
DHSLA44100Construction of Horizontals - L44 4.00 05-Nov-14 09-Nov-14 10-Nov-14 13-Nov-14 0% 0% -4.00
DHCWA45110Construction of Verticals - L44 2.00 10-Nov-14 11-Nov-14 15-Nov-14 16-Nov-14 0% 0% -4.00
STAIRCASES 5.00 04-Jan-15 08-Jan-15 08-Jan-15 13-Jan-15 0% 0% 40.00
A2070 Stair # 2 4.00 04-Jan-15 07-Jan-15 08-Jan-15 12-Jan-15 0% 0% 41.00
A2060 Stair # 1 4.00 05-Jan-15 08-Jan-15 10-Jan-15 13-Jan-15 0% 0% 8.00
LEVEL 45 63.00 30-Oct-14 13-Jan-15 04-Nov-14 18-Jan-15 0% 0% 40.00
STRUCTURAL WORKS - LEVEL 45 16.00 30-Oct-14 17-Nov-14 04-Nov-14 22-Nov-14 0% 0% -4.00
DHCWA46120Tower Crane Jump 1.00 30-Oct-14 30-Oct-14 04-Nov-14 04-Nov-14 0% 0% -1.00
DHCWA46100Core Wall - L45 4.00 30-Oct-14 03-Nov-14 04-Nov-14 08-Nov-14 0% 0% -4.00
DHSLA45100Construction of Horizontals - L45 4.00 11-Nov-14 15-Nov-14 16-Nov-14 19-Nov-14 0% 0% -4.00
DHCWA46110Construction of Verticals - L45 2.00 16-Nov-14 17-Nov-14 20-Nov-14 22-Nov-14 0% 0% -4.00
STAIRCASES 5.00 08-Jan-15 13-Jan-15 13-Jan-15 18-Jan-15 0% 0% 40.00
A2090 Stair # 2 4.00 08-Jan-15 12-Jan-15 13-Jan-15 17-Jan-15 0% 0% 41.00
A2080 Stair # 1 4.00 10-Jan-15 13-Jan-15 14-Jan-15 18-Jan-15 0% 0% 8.00
LEVEL 46 63.00 04-Nov-14 18-Jan-15 09-Nov-14 22-Jan-15 0% 0% 40.00
STRUCTURAL WORKS - LEVEL 46 17.00 04-Nov-14 23-Nov-14 09-Nov-14 27-Nov-14 0% 0% -4.00
DHCWA47100Core Wall - L46 5.00 04-Nov-14 09-Nov-14 09-Nov-14 13-Nov-14 0% 0% -4.00
DHSLA46100Construction of Horizontals - L46 4.00 17-Nov-14 20-Nov-14 22-Nov-14 25-Nov-14 0% 0% -4.00
2014 2015 2016 2017
Stair # 2
Stair # 1
Tower Crane Jump
Core Wall - L41
Construction of Horizontals - L41
Construction of Verticals - L41
Stair # 2
Stair # 1
Core Wall - L42
Construction of Horizontals - L42
Construction of Verticals - L42
Stair # 2
Stair # 1
Core Wall - L43
Construction of Horizontals - L43
Construction of Verticals - L43
Stair # 2
Stair # 1
Core Wall - L44
Construction of Horizontals - L44
Construction of Verticals - L44
Stair # 2
Stair # 1
Tower Crane Jump
Core Wall - L45
Construction of Horizontals - L45
Construction of Verticals - L45
Stair # 2
Stair # 1
Core Wall - L46
Construction of Horizontals - L46
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 10 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
DHCWA47110Construction of Verticals - L46 2.00 22-Nov-14 23-Nov-14 26-Nov-14 27-Nov-14 0% 0% -4.00
STAIRCASES 5.00 13-Jan-15 18-Jan-15 18-Jan-15 22-Jan-15 0% 0% 40.00
A2110 Stair # 2 4.00 13-Jan-15 17-Jan-15 18-Jan-15 21-Jan-15 0% 0% 41.00
A2100 Stair # 1 4.00 14-Jan-15 18-Jan-15 19-Jan-15 22-Jan-15 0% 0% 8.00
LEVEL 47 62.00 10-Nov-14 22-Jan-15 15-Nov-14 27-Jan-15 0% 0% 40.00
STRUCTURAL WORKS - LEVEL 47 16.00 10-Nov-14 27-Nov-14 15-Nov-14 03-Dec-14 0% 0% -4.00
DHCWA48100Core Wall - L47 5.00 10-Nov-14 15-Nov-14 15-Nov-14 19-Nov-14 0% 0% -4.00
DHSLA47100Construction of Horizontals - L47 4.00 22-Nov-14 25-Nov-14 26-Nov-14 30-Nov-14 0% 0% -4.00
DHCWA48110Construction of Verticals - L47 2.00 26-Nov-14 27-Nov-14 01-Dec-14 03-Dec-14 0% 0% -4.00
STAIRCASES 5.00 18-Jan-15 22-Jan-15 22-Jan-15 27-Jan-15 0% 0% 40.00
A2130 Stair # 2 4.00 18-Jan-15 21-Jan-15 22-Jan-15 26-Jan-15 0% 0% 41.00
A2120 Stair # 1 4.00 19-Jan-15 22-Jan-15 24-Jan-15 27-Jan-15 0% 0% 8.00
LEVEL 48 61.00 16-Nov-14 27-Jan-15 20-Nov-14 01-Feb-15 0% 0% 40.00
STRUCTURAL WORKS - LEVEL 48 15.00 16-Nov-14 03-Dec-14 20-Nov-14 08-Dec-14 0% 0% -4.00
DHCWA49120Tower Crane Jump 1.00 16-Nov-14 16-Nov-14 20-Nov-14 20-Nov-14 0% 0% -1.00
DHCWA49100Core Wall - L48 4.00 16-Nov-14 19-Nov-14 20-Nov-14 24-Nov-14 0% 0% -4.00
DHSLA48100Construction of Horizontals - L48 4.00 26-Nov-14 30-Nov-14 01-Dec-14 06-Dec-14 0% 0% -4.00
DHCWA49110Construction of Verticals - L48 2.00 01-Dec-14 03-Dec-14 07-Dec-14 08-Dec-14 0% 0% -4.00
STAIRCASES 5.00 22-Jan-15 27-Jan-15 27-Jan-15 01-Feb-15 0% 0% 40.00
A2150 Stair # 2 4.00 22-Jan-15 26-Jan-15 27-Jan-15 31-Jan-15 0% 0% 41.00
A2140 Stair # 1 4.00 24-Jan-15 27-Jan-15 28-Jan-15 01-Feb-15 0% 0% 8.00
LEVEL 49 61.00 20-Nov-14 01-Feb-15 25-Nov-14 05-Feb-15 0% 0% 40.00
STRUCTURAL WORKS - LEVEL 49 14.00 20-Nov-14 07-Dec-14 25-Nov-14 11-Dec-14 0% 0% -4.00
DHCWA50100Core Wall - L49 4.00 20-Nov-14 24-Nov-14 25-Nov-14 29-Nov-14 0% 0% -4.00
DHSLA49100Construction of Horizontals - L49 4.00 30-Nov-14 04-Dec-14 06-Dec-14 09-Dec-14 0% 0% -4.00
DHCWA50110Construction of Verticals - L49 2.00 06-Dec-14 07-Dec-14 10-Dec-14 11-Dec-14 0% 0% -4.00
STAIRCASES 5.00 27-Jan-15 01-Feb-15 01-Feb-15 05-Feb-15 0% 0% 40.00
A2170 Stair # 2 4.00 27-Jan-15 31-Jan-15 01-Feb-15 04-Feb-15 0% 0% 41.00
A2160 Stair # 1 4.00 28-Jan-15 01-Feb-15 02-Feb-15 05-Feb-15 0% 0% 8.00
LEVEL 50 61.00 25-Nov-14 05-Feb-15 30-Nov-14 10-Feb-15 0% 0% 40.00
STRUCTURAL WORKS - LEVEL 50 14.00 25-Nov-14 11-Dec-14 30-Nov-14 16-Dec-14 0% 0% -4.00
DHCWA51100Core Wall - L50 4.00 25-Nov-14 29-Nov-14 30-Nov-14 04-Dec-14 0% 0% -4.00
DHSLA50100Construction of Horizontals - L50 4.00 06-Dec-14 09-Dec-14 10-Dec-14 14-Dec-14 0% 0% -4.00
DHCWA51110Construction of Verticals - L50 2.00 10-Dec-14 11-Dec-14 15-Dec-14 16-Dec-14 0% 0% -4.00
STAIRCASES 5.00 01-Feb-15 05-Feb-15 05-Feb-15 10-Feb-15 0% 0% 40.00
A2190 Stair # 2 4.00 01-Feb-15 04-Feb-15 05-Feb-15 09-Feb-15 0% 0% 41.00
A2180 Stair # 1 4.00 02-Feb-15 05-Feb-15 07-Feb-15 10-Feb-15 0% 0% 8.00
LEVEL 51 61.00 30-Nov-14 10-Feb-15 06-Dec-14 15-Feb-15 0% 0% 40.00
STRUCTURAL WORKS - LEVEL 51 14.00 30-Nov-14 16-Dec-14 06-Dec-14 21-Dec-14 0% 0% -4.00
DHCWA52100Core Wall - L51 4.00 30-Nov-14 04-Dec-14 06-Dec-14 09-Dec-14 0% 0% -4.00
DHSLA51100Construction of Horizontals - L51 4.00 10-Dec-14 14-Dec-14 15-Dec-14 18-Dec-14 0% 0% -4.00
DHCWA52110Construction of Verticals - L51 2.00 15-Dec-14 16-Dec-14 20-Dec-14 21-Dec-14 0% 0% -4.00
STAIRCASES 5.00 05-Feb-15 10-Feb-15 10-Feb-15 15-Feb-15 0% 0% 40.00
A2210 Stair # 2 4.00 05-Feb-15 09-Feb-15 10-Feb-15 14-Feb-15 0% 0% 41.00
A2200 Stair # 1 4.00 07-Feb-15 10-Feb-15 11-Feb-15 15-Feb-15 0% 0% 8.00
LEVEL 52 62.00 06-Dec-14 16-Feb-15 10-Dec-14 21-Feb-15 0% 0% 39.00
STRUCTURAL WORKS - LEVEL 52 14.00 06-Dec-14 21-Dec-14 10-Dec-14 25-Dec-14 0% 0% -4.00
DHCWA53120Tower Crane Jump 1.00 06-Dec-14 06-Dec-14 10-Dec-14 10-Dec-14 0% 0% -1.00
DHCWA53100Core Wall - L52 4.00 06-Dec-14 09-Dec-14 10-Dec-14 14-Dec-14 0% 0% -4.00
2014 2015 2016 2017
Construction of Verticals - L46
Stair # 2
Stair # 1
Core Wall - L47
Construction of Horizontals - L47
Construction of Verticals - L47
Stair # 2
Stair # 1
Tower Crane Jump
Core Wall - L48
Construction of Horizontals - L48
Construction of Verticals - L48
Stair # 2
Stair # 1
Core Wall - L49
Construction of Horizontals - L49
Construction of Verticals - L49
Stair # 2
Stair # 1
Core Wall - L50
Construction of Horizontals - L50
Construction of Verticals - L50
Stair # 2
Stair # 1
Core Wall - L51
Construction of Horizontals - L51
Construction of Verticals - L51
Stair # 2
Stair # 1
Tower Crane Jump
Core Wall - L52
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 11 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
DHSLA52100Construction of Horizontals - L52 4.00 15-Dec-14 18-Dec-14 20-Dec-14 23-Dec-14 0% 0% -4.00
DHCWA53110Construction of Verticals - L52 2.00 20-Dec-14 21-Dec-14 24-Dec-14 25-Dec-14 0% 0% -4.00
STAIRCASES 4.00 12-Feb-15 16-Feb-15 17-Feb-15 21-Feb-15 0% 0% 39.00
A2220 Stair # 1 4.00 12-Feb-15 16-Feb-15 17-Feb-15 21-Feb-15 0% 0% 7.00
A2230 Stair # 2 4.00 12-Feb-15 16-Feb-15 17-Feb-15 21-Feb-15 0% 0% 39.00
LEVEL 53 62.00 10-Dec-14 21-Feb-15 15-Dec-14 25-Feb-15 0% 0% 39.00
STRUCTURAL WORKS - LEVEL 53 14.00 10-Dec-14 25-Dec-14 15-Dec-14 30-Dec-14 0% 0% -4.00
DHCWA54100Core Wall - L53 4.00 10-Dec-14 14-Dec-14 15-Dec-14 18-Dec-14 0% 0% -4.00
DHSLA53100Construction of Horizontals - L53 4.00 20-Dec-14 23-Dec-14 24-Dec-14 28-Dec-14 0% 0% -4.00
DHCWA54110Construction of Verticals - L53 2.00 24-Dec-14 25-Dec-14 29-Dec-14 30-Dec-14 0% 0% -4.00
STAIRCASES 4.00 17-Feb-15 21-Feb-15 22-Feb-15 25-Feb-15 0% 0% 39.00
A2240 Stair # 1 4.00 17-Feb-15 21-Feb-15 22-Feb-15 25-Feb-15 0% 0% 7.00
A2250 Stair # 2 4.00 17-Feb-15 21-Feb-15 22-Feb-15 25-Feb-15 0% 0% 39.00
LEVEL 54 62.00 15-Dec-14 25-Feb-15 20-Dec-14 02-Mar-15 0% 0% 39.00
STRUCTURAL WORKS - LEVEL 54 13.00 15-Dec-14 29-Dec-14 20-Dec-14 04-Jan-15 0% 0% -4.00
DHCWA55100Core Wall - L54 4.00 15-Dec-14 18-Dec-14 20-Dec-14 23-Dec-14 0% 0% -4.00
DHSLA54100Construction of Horizontals - L54 4.00 23-Dec-14 27-Dec-14 28-Dec-14 31-Dec-14 0% 0% -4.00
DHCWA55110Construction of Verticals - L54 2.00 28-Dec-14 29-Dec-14 03-Jan-15 04-Jan-15 0% 0% -4.00
STAIRCASES 4.00 22-Feb-15 25-Feb-15 26-Feb-15 02-Mar-15 0% 0% 39.00
A2260 Stair # 1 4.00 22-Feb-15 25-Feb-15 26-Feb-15 02-Mar-15 0% 0% 7.00
A2270 Stair # 2 4.00 22-Feb-15 25-Feb-15 26-Feb-15 02-Mar-15 0% 0% 39.00
LEVEL 55 62.00 20-Dec-14 02-Mar-15 24-Dec-14 07-Mar-15 0% 0% 39.00
STRUCTURAL WORKS - LEVEL 55 13.00 20-Dec-14 04-Jan-15 24-Dec-14 08-Jan-15 0% 0% -4.00
DHCWA56100Core Wall - L55 4.00 20-Dec-14 23-Dec-14 24-Dec-14 28-Dec-14 0% 0% -4.00
DHSLA55100Construction of Horizontals - L55 3.00 29-Dec-14 31-Dec-14 04-Jan-15 06-Jan-15 0% 0% -4.00
DHCWA56110Construction of Verticals - L55 2.00 03-Jan-15 04-Jan-15 07-Jan-15 08-Jan-15 0% 0% -4.00
STAIRCASES 4.00 26-Feb-15 02-Mar-15 03-Mar-15 07-Mar-15 0% 0% 39.00
A2280 Stair # 1 4.00 26-Feb-15 02-Mar-15 03-Mar-15 07-Mar-15 0% 0% 7.00
A2290 Stair # 2 4.00 26-Feb-15 02-Mar-15 03-Mar-15 07-Mar-15 0% 0% 39.00
LEVEL 56 62.00 24-Dec-14 07-Mar-15 29-Dec-14 11-Mar-15 0% 0% 38.00
STRUCTURAL WORKS - LEVEL 56 13.00 24-Dec-14 08-Jan-15 29-Dec-14 13-Jan-15 0% 0% -4.00
DHCWA57120Tower Crane Jump 1.00 24-Dec-14 24-Dec-14 29-Dec-14 29-Dec-14 0% 0% -1.00
DHCWA57100Core Wall - L56 4.00 24-Dec-14 28-Dec-14 29-Dec-14 03-Jan-15 0% 0% -4.00
DHSLA56100Construction of Horizontals - L56 3.00 04-Jan-15 06-Jan-15 08-Jan-15 11-Jan-15 0% 0% -4.00
DHCWA57110Construction of Verticals - L56 2.00 07-Jan-15 08-Jan-15 12-Jan-15 13-Jan-15 0% 0% -4.00
STAIRCASES 4.00 03-Mar-15 07-Mar-15 08-Mar-15 11-Mar-15 0% 0% 38.00
A2310 Stair # 2 3.00 03-Mar-15 05-Mar-15 08-Mar-15 10-Mar-15 0% 0% 39.00
A2300 Stair # 1 4.00 03-Mar-15 07-Mar-15 08-Mar-15 11-Mar-15 0% 0% 7.00
LEVEL 57 62.00 29-Dec-14 11-Mar-15 04-Jan-15 16-Mar-15 0% 0% 38.00
STRUCTURAL WORKS - LEVEL 57 12.00 29-Dec-14 12-Jan-15 04-Jan-15 17-Jan-15 0% 0% -4.00
DHCWA58100Core Wall - L57 3.00 29-Dec-14 31-Dec-14 04-Jan-15 06-Jan-15 0% 0% -4.00
DHSLA57100Construction of Horizontals - L57 4.00 06-Jan-15 10-Jan-15 11-Jan-15 14-Jan-15 0% 0% -4.00
DHCWA58110Construction of Verticals - L57 2.00 11-Jan-15 12-Jan-15 15-Jan-15 17-Jan-15 0% 0% -4.00
STAIRCASES 5.00 07-Mar-15 11-Mar-15 11-Mar-15 16-Mar-15 0% 0% 38.00
A2330 Stair # 2 4.00 07-Mar-15 10-Mar-15 11-Mar-15 15-Mar-15 0% 0% 39.00
A2320 Stair # 1 4.00 08-Mar-15 11-Mar-15 12-Mar-15 16-Mar-15 0% 0% 7.00
LEVEL 58 63.00 03-Jan-15 16-Mar-15 07-Jan-15 21-Mar-15 0% 0% 38.00
STRUCTURAL WORKS - LEVEL 58 13.00 03-Jan-15 17-Jan-15 07-Jan-15 21-Jan-15 0% 0% -4.00
DHCWA59100Core Wall - L58 3.00 03-Jan-15 05-Jan-15 07-Jan-15 10-Jan-15 0% 0% -4.00
2014 2015 2016 2017
Construction of Horizontals - L52
Construction of Verticals - L52
Stair # 1
Stair # 2
Core Wall - L53
Construction of Horizontals - L53
Construction of Verticals - L53
Stair # 1
Stair # 2
Core Wall - L54
Construction of Horizontals - L54
Construction of Verticals - L54
Stair # 1
Stair # 2
Core Wall - L55
Construction of Horizontals - L55
Construction of Verticals - L55
Stair # 1
Stair # 2
Tower Crane Jump
Core Wall - L56
Construction of Horizontals - L56
Construction of Verticals - L56
Stair # 2
Stair # 1
Core Wall - L57
Construction of Horizontals - L57
Construction of Verticals - L57
Stair # 2
Stair # 1
Core Wall - L58
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 12 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
DHSLA58100Construction of Horizontals - L58 4.00 11-Jan-15 14-Jan-15 15-Jan-15 19-Jan-15 0% 0% -4.00
DHCWA59110Construction of Verticals - L58 2.00 15-Jan-15 17-Jan-15 20-Jan-15 21-Jan-15 0% 0% -4.00
STAIRCASES 5.00 11-Mar-15 16-Mar-15 16-Mar-15 21-Mar-15 0% 0% 38.00
A2350 Stair # 2 4.00 11-Mar-15 15-Mar-15 16-Mar-15 19-Mar-15 0% 0% 39.00
A2340 Stair # 1 4.00 12-Mar-15 16-Mar-15 17-Mar-15 21-Mar-15 0% 0% 7.00
LEVEL 59 64.00 06-Jan-15 21-Mar-15 11-Jan-15 25-Mar-15 0% 0% 37.00
STRUCTURAL WORKS - LEVEL 59 13.00 06-Jan-15 20-Jan-15 11-Jan-15 25-Jan-15 0% 0% -4.00
DHCWA60100Core Wall - L59 4.00 06-Jan-15 10-Jan-15 11-Jan-15 14-Jan-15 0% 0% -4.00
DHSLA59100Construction of Horizontals - L59 3.00 15-Jan-15 18-Jan-15 20-Jan-15 22-Jan-15 0% 0% -4.00
DHCWA60110Construction of Verticals - L59 2.00 19-Jan-15 20-Jan-15 24-Jan-15 25-Jan-15 0% 0% -4.00
STAIRCASES 5.00 16-Mar-15 21-Mar-15 21-Mar-15 25-Mar-15 0% 0% 37.00
A2370 Stair # 2 3.00 16-Mar-15 18-Mar-15 21-Mar-15 23-Mar-15 0% 0% 39.00
A2360 Stair # 1 4.00 17-Mar-15 21-Mar-15 22-Mar-15 25-Mar-15 0% 0% 7.00
LEVEL 60 64.00 11-Jan-15 25-Mar-15 15-Jan-15 30-Mar-15 0% 0% 36.00
STRUCTURAL WORKS - LEVEL 60 13.00 11-Jan-15 25-Jan-15 15-Jan-15 29-Jan-15 0% 0% -4.00
DHCWA61120Tower Crane Jump 1.00 11-Jan-15 11-Jan-15 15-Jan-15 15-Jan-15 0% 0% -2.00
DHCWA61100Core Wall - L 60 3.00 11-Jan-15 13-Jan-15 15-Jan-15 18-Jan-15 0% 0% -4.00
DHSLA60100Construction of Horizontal - L60 3.00 20-Jan-15 22-Jan-15 25-Jan-15 27-Jan-15 0% 0% -4.00
DHCWA61110Construction of Verticals - L60 2.00 24-Jan-15 25-Jan-15 28-Jan-15 29-Jan-15 0% 0% -4.00
STAIRCASES 6.00 19-Mar-15 25-Mar-15 24-Mar-15 30-Mar-15 0% 0% 36.00
A2390 Stair # 2 3.00 19-Mar-15 22-Mar-15 24-Mar-15 26-Mar-15 0% 0% 39.00
A2380 Stair # 1 4.00 22-Mar-15 25-Mar-15 26-Mar-15 30-Mar-15 0% 0% 7.00
LEVEL 61 65.00 14-Jan-15 30-Mar-15 19-Jan-15 04-Apr-15 0% 0% 35.00
STRUCTURAL WORKS - LEVEL 61 13.00 14-Jan-15 28-Jan-15 19-Jan-15 02-Feb-15 0% 0% -4.00
DHCWA62100Core Wall - L61 3.00 14-Jan-15 17-Jan-15 19-Jan-15 21-Jan-15 0% 0% -4.00
DHSLA61100Construction of Horizontal - L61 3.00 24-Jan-15 26-Jan-15 28-Jan-15 31-Jan-15 0% 0% -4.00
DHCWA62110Construction of Verticals - L61 2.00 27-Jan-15 28-Jan-15 01-Feb-15 02-Feb-15 0% 0% -4.00
STAIRCASES 7.00 23-Mar-15 30-Mar-15 28-Mar-15 04-Apr-15 0% 0% 35.00
A2410 Stair # 2 3.00 23-Mar-15 25-Mar-15 28-Mar-15 30-Mar-15 0% 0% 39.00
A2400 Stair # 1 4.00 26-Mar-15 30-Mar-15 31-Mar-15 04-Apr-15 0% 0% 7.00
LEVELS 62 (MECHANICAL FLOOR) 66.00 18-Jan-15 04-Apr-15 22-Jan-15 08-Apr-15 0% 0% 34.00
LEVEL 62 66.00 18-Jan-15 04-Apr-15 22-Jan-15 08-Apr-15 0% 0% 34.00
STRUCTURAL WORKS - LEVEL 62 18.00 18-Jan-15 07-Feb-15 22-Jan-15 11-Feb-15 0% 0% -4.00
DHCWA63100Core Wall - L62 6.00 18-Jan-15 24-Jan-15 22-Jan-15 28-Jan-15 0% 0% -4.00
DHSLA62100Construction of Horizontal - L62 ( Mech . Floor ) 5.00 29-Jan-15 03-Feb-15 03-Feb-15 08-Feb-15 0% 0% -4.00
DHCWA63110Construction of Verticals - L62 ( Mech . Floor ) 3.00 04-Feb-15 07-Feb-15 09-Feb-15 11-Feb-15 0% 0% -4.00
STAIRCASES 7.00 28-Mar-15 04-Apr-15 01-Apr-15 08-Apr-15 0% 0% 34.00
A2430 Stair # 2 3.00 28-Mar-15 30-Mar-15 01-Apr-15 04-Apr-15 0% 0% 38.00
A2420 Stair # 1 4.00 31-Mar-15 04-Apr-15 05-Apr-15 08-Apr-15 0% 0% 7.00
LEVELS 63-85 148.00 25-Jan-15 16-Jul-15 29-Jan-15 23-Jul-15 0% 0% 12.00
LEVEL 63 64.00 25-Jan-15 08-Apr-15 29-Jan-15 13-Apr-15 0% 0% 33.00
STRUCTURAL WORKS - LEVEL 63 18.00 25-Jan-15 14-Feb-15 29-Jan-15 18-Feb-15 0% 0% -3.00
DHCWA64100Core Wall - L63 3.00 25-Jan-15 27-Jan-15 29-Jan-15 01-Feb-15 0% 0% -4.00
DHSLA63100Construction of Horizontal - L63 4.00 08-Feb-15 11-Feb-15 12-Feb-15 16-Feb-15 0% 0% -4.00
DHCWA64110Construction of Verticals - L63 2.00 12-Feb-15 14-Feb-15 17-Feb-15 18-Feb-15 0% 0% -3.00
STAIRCASES 8.00 31-Mar-15 08-Apr-15 05-Apr-15 13-Apr-15 0% 0% 33.00
A2450 Stair # 2 3.00 31-Mar-15 02-Apr-15 05-Apr-15 07-Apr-15 0% 0% 38.00
A2440 Stair # 1 4.00 05-Apr-15 08-Apr-15 09-Apr-15 13-Apr-15 0% 0% 7.00
LEVEL 64 65.00 28-Jan-15 13-Apr-15 02-Feb-15 18-Apr-15 0% 0% 32.00
2014 2015 2016 2017
Construction of Horizontals - L58
Construction of Verticals - L58
Stair # 2
Stair # 1
Core Wall - L59
Construction of Horizontals - L59
Construction of Verticals - L59
Stair # 2
Stair # 1
Tower Crane Jump
Core Wall - L 60
Construction of Horizontal - L60
Construction of Verticals - L60
Stair # 2
Stair # 1
Core Wall - L61
Construction of Horizontal - L61
Construction of Verticals - L61
Stair # 2
Stair # 1
Core Wall - L62
Construction of Horizontal - L62 ( Mech . Floor )
Construction of Verticals - L62 ( Mech . Floor )
Stair # 2
Stair # 1
Core Wall - L63
Construction of Horizontal - L63
Construction of Verticals - L63
Stair # 2
Stair # 1
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 13 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
STRUCTURAL WORKS - LEVEL 64 18.00 28-Jan-15 17-Feb-15 02-Feb-15 22-Feb-15 0% 0% -3.00
DHCWA65120Tower Crane Jump 1.00 28-Jan-15 28-Jan-15 02-Feb-15 02-Feb-15 0% 0% 0.00
DHCWA65100Core Wall - L64 5.00 28-Jan-15 02-Feb-15 02-Feb-15 07-Feb-15 0% 0% -4.00
DHSLA64100Construction of Horizontal - L64 3.00 12-Feb-15 15-Feb-15 17-Feb-15 19-Feb-15 0% 0% -3.00
DHCWA65110Construction of Verticals - L64 2.00 16-Feb-15 17-Feb-15 21-Feb-15 22-Feb-15 0% 0% -3.00
STAIRCASES 9.00 04-Apr-15 13-Apr-15 08-Apr-15 18-Apr-15 0% 0% 32.00
A2470 Stair # 2 3.00 04-Apr-15 06-Apr-15 08-Apr-15 11-Apr-15 0% 0% 38.00
A2460 Stair # 1 4.00 09-Apr-15 13-Apr-15 14-Apr-15 18-Apr-15 0% 0% 7.00
LEVEL 65 64.00 03-Feb-15 18-Apr-15 08-Feb-15 22-Apr-15 0% 0% 31.00
STRUCTURAL WORKS - LEVEL 65 17.00 03-Feb-15 22-Feb-15 08-Feb-15 26-Feb-15 0% 0% -3.00
DHCWA66100Core Wall - L65 5.00 03-Feb-15 08-Feb-15 08-Feb-15 12-Feb-15 0% 0% -4.00
DHSLA65100Construction of Horizontals - L65 3.00 17-Feb-15 19-Feb-15 22-Feb-15 24-Feb-15 0% 0% -3.00
DHCWA66110Construction of Verticals - L65 2.00 21-Feb-15 22-Feb-15 25-Feb-15 26-Feb-15 0% 0% -3.00
STAIRCASES 10.00 07-Apr-15 18-Apr-15 12-Apr-15 22-Apr-15 0% 0% 31.00
A2490 Stair # 2 3.00 07-Apr-15 09-Apr-15 12-Apr-15 14-Apr-15 0% 0% 38.00
A2480 Stair # 1 4.00 14-Apr-15 18-Apr-15 19-Apr-15 22-Apr-15 0% 0% 7.00
LEVEL 66 63.00 09-Feb-15 22-Apr-15 14-Feb-15 27-Apr-15 0% 0% 30.00
STRUCTURAL WORKS - LEVEL 66 16.00 09-Feb-15 26-Feb-15 14-Feb-15 03-Mar-15 0% 0% -3.00
DHCWA67100Core Wall - L66 5.00 09-Feb-15 14-Feb-15 14-Feb-15 18-Feb-15 0% 0% -4.00
DHSLA66100Construction of Horizontals - L66 3.00 22-Feb-15 24-Feb-15 26-Feb-15 01-Mar-15 0% 0% -3.00
DHCWA67110Construction of Verticals - L66 2.00 25-Feb-15 26-Feb-15 02-Mar-15 03-Mar-15 0% 0% -3.00
STAIRCASES 11.00 11-Apr-15 22-Apr-15 15-Apr-15 27-Apr-15 0% 0% 30.00
A2510 Stair # 2 3.00 11-Apr-15 13-Apr-15 15-Apr-15 18-Apr-15 0% 0% 38.00
A2500 Stair # 1 4.00 19-Apr-15 22-Apr-15 23-Apr-15 27-Apr-15 0% 0% 7.00
LEVEL 67 62.00 15-Feb-15 27-Apr-15 19-Feb-15 02-May-15 0% 0% 29.00
STRUCTURAL WORKS - LEVEL 67 14.00 15-Feb-15 02-Mar-15 19-Feb-15 07-Mar-15 0% 0% -3.00
DHCWA68120Tower Crane Jump 1.00 15-Feb-15 15-Feb-15 19-Feb-15 19-Feb-15 0% 0% -1.00
DHCWA68100Core Wall - L67 4.00 15-Feb-15 18-Feb-15 19-Feb-15 23-Feb-15 0% 0% -4.00
DHSLA67100Construction of Horizontals - L67 3.00 25-Feb-15 28-Feb-15 02-Mar-15 04-Mar-15 0% 0% -3.00
DHCWA68110Construction of Verticals - L67 2.00 01-Mar-15 02-Mar-15 05-Mar-15 07-Mar-15 0% 0% -3.00
STAIRCASES 12.00 14-Apr-15 27-Apr-15 19-Apr-15 02-May-15 0% 0% 29.00
A2530 Stair # 2 3.00 14-Apr-15 16-Apr-15 19-Apr-15 21-Apr-15 0% 0% 38.00
A2520 Stair # 1 4.00 23-Apr-15 27-Apr-15 28-Apr-15 02-May-15 0% 0% 7.00
LEVEL 68 62.00 19-Feb-15 02-May-15 24-Feb-15 06-May-15 0% 0% 28.00
STRUCTURAL WORKS - LEVEL 68 14.00 19-Feb-15 07-Mar-15 24-Feb-15 11-Mar-15 0% 0% -2.00
DHCWA69100Core Wall - L68 4.00 19-Feb-15 23-Feb-15 24-Feb-15 28-Feb-15 0% 0% -4.00
DHSLA68100Construction of Horizontals - L68 3.00 02-Mar-15 04-Mar-15 07-Mar-15 09-Mar-15 0% 0% -3.00
DHCWA69110Construction of Verticals - L68 2.00 05-Mar-15 07-Mar-15 10-Mar-15 11-Mar-15 0% 0% -2.00
STAIRCASES 13.00 18-Apr-15 02-May-15 22-Apr-15 06-May-15 0% 0% 28.00
A2550 Stair # 2 3.00 18-Apr-15 20-Apr-15 22-Apr-15 25-Apr-15 0% 0% 38.00
A2540 Stair # 1 4.00 28-Apr-15 02-May-15 03-May-15 06-May-15 0% 0% 7.00
LEVEL 69 62.00 24-Feb-15 06-May-15 01-Mar-15 11-May-15 0% 0% 27.00
STRUCTURAL WORKS - LEVEL 69 14.00 24-Feb-15 11-Mar-15 01-Mar-15 16-Mar-15 0% 0% -2.00
DHCWA70100Core Wall - L69 4.00 24-Feb-15 28-Feb-15 01-Mar-15 04-Mar-15 0% 0% -4.00
DHSLA69100Construction of Horizontals - L69 3.00 07-Mar-15 09-Mar-15 11-Mar-15 14-Mar-15 0% 0% -2.00
DHCWA70110Construction of Verticals - L69 2.00 10-Mar-15 11-Mar-15 15-Mar-15 16-Mar-15 0% 0% -2.00
STAIRCASES 13.00 22-Apr-15 06-May-15 27-Apr-15 11-May-15 0% 0% 27.00
A2570 Stair # 2 3.00 22-Apr-15 25-Apr-15 27-Apr-15 29-Apr-15 0% 0% 37.00
2014 2015 2016 2017
Tower Crane Jump
Core Wall - L64
Construction of Horizontal - L64
Construction of Verticals - L64
Stair # 2
Stair # 1
Core Wall - L65
Construction of Horizontals - L65
Construction of Verticals - L65
Stair # 2
Stair # 1
Core Wall - L66
Construction of Horizontals - L66
Construction of Verticals - L66
Stair # 2
Stair # 1
Tower Crane Jump
Core Wall - L67
Construction of Horizontals - L67
Construction of Verticals - L67
Stair # 2
Stair # 1
Core Wall - L68
Construction of Horizontals - L68
Construction of Verticals - L68
Stair # 2
Stair # 1
Core Wall - L69
Construction of Horizontals - L69
Construction of Verticals - L69
Stair # 2
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 14 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
A2560 Stair # 1 4.00 03-May-15 06-May-15 07-May-15 11-May-15 0% 0% 7.00
LEVEL 70 62.00 01-Mar-15 11-May-15 05-Mar-15 17-May-15 0% 0% 26.00
STRUCTURAL WORKS - LEVEL 70 13.00 01-Mar-15 15-Mar-15 05-Mar-15 19-Mar-15 0% 0% -2.00
DHCWA71120Tower Crane Jump 1.00 01-Mar-15 01-Mar-15 05-Mar-15 05-Mar-15 0% 0% 0.00
DHCWA71100Core Wall - L70 5.00 01-Mar-15 05-Mar-15 05-Mar-15 10-Mar-15 0% 0% -4.00
DHSLA70100Construction of Horizontals - L70 3.00 10-Mar-15 12-Mar-15 15-Mar-15 17-Mar-15 0% 0% -2.00
DHCWA71110Construction of Verticals - L70 2.00 14-Mar-15 15-Mar-15 18-Mar-15 19-Mar-15 0% 0% -2.00
STAIRCASES 14.00 26-Apr-15 11-May-15 30-Apr-15 17-May-15 0% 0% 26.00
A2590 Stair # 2 3.00 26-Apr-15 28-Apr-15 30-Apr-15 03-May-15 0% 0% 37.00
A2580 Stair # 1 4.00 07-May-15 11-May-15 12-May-15 17-May-15 0% 0% 7.00
LEVEL 71 61.00 07-Mar-15 17-May-15 11-Mar-15 21-May-15 0% 0% 25.00
STRUCTURAL WORKS - LEVEL 71 11.00 07-Mar-15 18-Mar-15 11-Mar-15 23-Mar-15 0% 0% -2.00
DHCWA72100Core Wall - L71 4.00 07-Mar-15 10-Mar-15 11-Mar-15 15-Mar-15 0% 0% -4.00
DHSLA71100Construction of Horizontals - L71 3.00 14-Mar-15 16-Mar-15 18-Mar-15 21-Mar-15 0% 0% -2.00
DHCWA72110Construction of Verticals - L71 2.00 17-Mar-15 18-Mar-15 22-Mar-15 23-Mar-15 0% 0% -2.00
STAIRCASES 15.00 29-Apr-15 17-May-15 04-May-15 21-May-15 0% 0% 25.00
A2610 Stair # 2 3.00 29-Apr-15 02-May-15 04-May-15 06-May-15 0% 0% 37.00
A2600 Stair # 1 4.00 12-May-15 17-May-15 18-May-15 21-May-15 0% 0% 7.00
LEVEL 72 61.00 11-Mar-15 21-May-15 16-Mar-15 26-May-15 0% 0% 24.00
STRUCTURAL WORKS - LEVEL 72 11.00 11-Mar-15 23-Mar-15 16-Mar-15 28-Mar-15 0% 0% -3.00
DHCWA73100Core Wall - L72 4.00 11-Mar-15 15-Mar-15 16-Mar-15 19-Mar-15 0% 0% -4.00
DHSLA72100Construction of Horizontals - L72 3.00 18-Mar-15 21-Mar-15 23-Mar-15 25-Mar-15 0% 0% -3.00
DHCWA73110Construction of Verticals - L72 2.00 22-Mar-15 23-Mar-15 26-Mar-15 28-Mar-15 0% 0% -3.00
STAIRCASES 16.00 03-May-15 21-May-15 07-May-15 26-May-15 0% 0% 24.00
A2630 Stair # 2 3.00 03-May-15 05-May-15 07-May-15 10-May-15 0% 0% 37.00
A2620 Stair # 1 4.00 18-May-15 21-May-15 23-May-15 26-May-15 0% 0% 7.00
LEVEL 73 61.00 16-Mar-15 26-May-15 21-Mar-15 31-May-15 0% 0% 23.00
STRUCTURAL WORKS - LEVEL 73 11.00 16-Mar-15 28-Mar-15 21-Mar-15 01-Apr-15 0% 0% -4.00
DHCWA74100Core Wall - L73 4.00 16-Mar-15 19-Mar-15 21-Mar-15 24-Mar-15 0% 0% -4.00
DHSLA73100Construction of Horizontals - L73 3.00 23-Mar-15 25-Mar-15 28-Mar-15 30-Mar-15 0% 0% -4.00
DHCWA74110Construction of Verticals - L73 2.00 26-Mar-15 28-Mar-15 31-Mar-15 01-Apr-15 0% 0% -4.00
STAIRCASES 17.00 06-May-15 26-May-15 11-May-15 31-May-15 0% 0% 23.00
A2650 Stair # 2 3.00 06-May-15 09-May-15 11-May-15 13-May-15 0% 0% 37.00
A2640 Stair # 1 4.00 23-May-15 26-May-15 27-May-15 31-May-15 0% 0% 7.00
LEVEL 74 61.00 21-Mar-15 31-May-15 25-Mar-15 04-Jun-15 0% 0% 22.00
STRUCTURAL WORKS - LEVEL 74 10.00 21-Mar-15 31-Mar-15 25-Mar-15 05-Apr-15 0% 0% -4.00
DHCWA75120Tower Crane Jump 1.00 21-Mar-15 21-Mar-15 25-Mar-15 25-Mar-15 0% 0% -1.00
DHCWA75100Core Wall - L74 4.00 21-Mar-15 24-Mar-15 25-Mar-15 29-Mar-15 0% 0% -4.00
DHSLA74100Construction of Horizontals - L74 3.00 26-Mar-15 29-Mar-15 31-Mar-15 02-Apr-15 0% 0% -4.00
DHCWA75110Construction of Verticals - L74 2.00 30-Mar-15 31-Mar-15 04-Apr-15 05-Apr-15 0% 0% -4.00
STAIRCASES 18.00 10-May-15 31-May-15 14-May-15 04-Jun-15 0% 0% 22.00
A2670 Stair # 2 3.00 10-May-15 12-May-15 14-May-15 18-May-15 0% 0% 37.00
A2660 Stair # 1 4.00 27-May-15 31-May-15 01-Jun-15 04-Jun-15 0% 0% 7.00
LEVEL 75 61.00 25-Mar-15 04-Jun-15 30-Mar-15 09-Jun-15 0% 0% 21.00
STRUCTURAL WORKS - LEVEL 75 9.00 25-Mar-15 04-Apr-15 30-Mar-15 08-Apr-15 0% 0% -4.00
DHCWA76100Core Wall - L75 3.00 25-Mar-15 28-Mar-15 30-Mar-15 01-Apr-15 0% 0% -4.00
DHSLA75100Construction of Horizontals - L75 3.00 30-Mar-15 01-Apr-15 04-Apr-15 06-Apr-15 0% 0% -4.00
DHCWA76110Construction of Verticals - L75 2.00 02-Apr-15 04-Apr-15 07-Apr-15 08-Apr-15 0% 0% -4.00
STAIRCASES 19.00 13-May-15 04-Jun-15 19-May-15 09-Jun-15 0% 0% 21.00
2014 2015 2016 2017
Stair # 1
Tower Crane Jump
Core Wall - L70
Construction of Horizontals - L70
Construction of Verticals - L70
Stair # 2
Stair # 1
Core Wall - L71
Construction of Horizontals - L71
Construction of Verticals - L71
Stair # 2
Stair # 1
Core Wall - L72
Construction of Horizontals - L72
Construction of Verticals - L72
Stair # 2
Stair # 1
Core Wall - L73
Construction of Horizontals - L73
Construction of Verticals - L73
Stair # 2
Stair # 1
Tower Crane Jump
Core Wall - L74
Construction of Horizontals - L74
Construction of Verticals - L74
Stair # 2
Stair # 1
Core Wall - L75
Construction of Horizontals - L75
Construction of Verticals - L75
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 15 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
A2690 Stair # 2 3.00 13-May-15 17-May-15 19-May-15 21-May-15 0% 0% 37.00
A2680 Stair # 1 4.00 01-Jun-15 04-Jun-15 06-Jun-15 09-Jun-15 0% 0% 7.00
LEVEL 76 62.00 29-Mar-15 09-Jun-15 02-Apr-15 14-Jun-15 0% 0% 20.00
STRUCTURAL WORKS - LEVEL 76 9.00 29-Mar-15 07-Apr-15 02-Apr-15 12-Apr-15 0% 0% -4.00
DHCWA77100Core Wall - L76 3.00 29-Mar-15 31-Mar-15 02-Apr-15 05-Apr-15 0% 0% -4.00
DHSLA76100Construction of Horizontals - L76 3.00 02-Apr-15 05-Apr-15 07-Apr-15 09-Apr-15 0% 0% -4.00
DHCWA77110Construction of Verticals - L76 2.00 06-Apr-15 07-Apr-15 11-Apr-15 12-Apr-15 0% 0% -4.00
STAIRCASES 20.00 18-May-15 09-Jun-15 23-May-15 14-Jun-15 0% 0% 20.00
A2710 Stair # 2 3.00 18-May-15 20-May-15 23-May-15 25-May-15 0% 0% 37.00
A2700 Stair # 1 4.00 06-Jun-15 09-Jun-15 10-Jun-15 14-Jun-15 0% 0% 7.00
LEVEL 77 63.00 01-Apr-15 14-Jun-15 06-Apr-15 18-Jun-15 0% 0% 19.00
STRUCTURAL WORKS - LEVEL 77 9.00 01-Apr-15 11-Apr-15 06-Apr-15 15-Apr-15 0% 0% -4.00
DHCWA78100Core Wall - L77 3.00 01-Apr-15 04-Apr-15 06-Apr-15 08-Apr-15 0% 0% -4.00
DHSLA77100Construction of Horizontals - L77 3.00 06-Apr-15 08-Apr-15 11-Apr-15 13-Apr-15 0% 0% -4.00
DHCWA78110Construction of Verticals - L77 2.00 09-Apr-15 11-Apr-15 14-Apr-15 15-Apr-15 0% 0% -4.00
STAIRCASES 21.00 21-May-15 14-Jun-15 26-May-15 18-Jun-15 0% 0% 19.00
A2730 Stair # 2 3.00 21-May-15 24-May-15 26-May-15 28-May-15 0% 0% 37.00
A2720 Stair # 1 4.00 10-Jun-15 14-Jun-15 15-Jun-15 18-Jun-15 0% 0% 7.00
LEVEL 78 64.00 05-Apr-15 18-Jun-15 09-Apr-15 23-Jun-15 0% 0% 18.00
STRUCTURAL WORKS - LEVEL 78 9.00 05-Apr-15 14-Apr-15 09-Apr-15 19-Apr-15 0% 0% -4.00
DHCWA79140Tower Crane Jump 1.00 05-Apr-15 05-Apr-15 09-Apr-15 09-Apr-15 0% 0% -2.00
DHCWA79100Core Wall - L78 3.00 05-Apr-15 07-Apr-15 09-Apr-15 12-Apr-15 0% 0% -4.00
DHSLA78100Construction of Horizontals - L78 3.00 09-Apr-15 12-Apr-15 14-Apr-15 16-Apr-15 0% 0% -4.00
DHCWA79110Construction of Verticals - L78 2.00 13-Apr-15 14-Apr-15 18-Apr-15 19-Apr-15 0% 0% -4.00
STAIRCASES 22.00 25-May-15 18-Jun-15 30-May-15 23-Jun-15 0% 0% 18.00
A2750 Stair # 2 3.00 25-May-15 27-May-15 30-May-15 01-Jun-15 0% 0% 37.00
A2740 Stair # 1 4.00 15-Jun-15 18-Jun-15 20-Jun-15 23-Jun-15 0% 0% 7.00
LEVEL 79 65.00 08-Apr-15 23-Jun-15 13-Apr-15 28-Jun-15 0% 0% 17.00
STRUCTURAL WORKS - LEVEL 79 9.00 08-Apr-15 18-Apr-15 13-Apr-15 22-Apr-15 0% 0% -4.00
DHCWA80100Core Wall - L79 3.00 08-Apr-15 11-Apr-15 13-Apr-15 15-Apr-15 0% 0% -4.00
DHSLA79100Construction of Horizontals - L79 3.00 13-Apr-15 15-Apr-15 18-Apr-15 20-Apr-15 0% 0% -4.00
DHCWA80110Construction of Verticals - L79 2.00 16-Apr-15 18-Apr-15 21-Apr-15 22-Apr-15 0% 0% -4.00
STAIRCASES 23.00 28-May-15 23-Jun-15 02-Jun-15 28-Jun-15 0% 0% 17.00
A2770 Stair # 2 3.00 28-May-15 31-May-15 02-Jun-15 04-Jun-15 0% 0% 37.00
A2760 Stair # 1 4.00 20-Jun-15 23-Jun-15 24-Jun-15 28-Jun-15 0% 0% 7.00
LEVEL 80 66.00 12-Apr-15 28-Jun-15 16-Apr-15 02-Jul-15 0% 0% 16.00
STRUCTURAL WORKS - LEVEL 80 10.00 12-Apr-15 22-Apr-15 16-Apr-15 27-Apr-15 0% 0% -4.00
DHCWA81100Core Wall - Level 80 3.00 12-Apr-15 14-Apr-15 16-Apr-15 19-Apr-15 0% 0% -4.00
DHSLA80100Construction of Horizontals - L80 3.00 18-Apr-15 20-Apr-15 22-Apr-15 25-Apr-15 0% 0% -4.00
DHCWA81110Construction of Verticals - L80 2.00 21-Apr-15 22-Apr-15 26-Apr-15 27-Apr-15 0% 0% -4.00
STAIRCASES 24.00 01-Jun-15 28-Jun-15 06-Jun-15 02-Jul-15 0% 0% 16.00
A2790 Stair # 2 3.00 01-Jun-15 03-Jun-15 06-Jun-15 08-Jun-15 0% 0% 37.00
A2780 Stair # 1 4.00 24-Jun-15 28-Jun-15 29-Jun-15 02-Jul-15 0% 0% 7.00
LEVEL 81 67.00 15-Apr-15 02-Jul-15 20-Apr-15 07-Jul-15 0% 0% 15.00
STRUCTURAL WORKS - LEVEL 81 10.00 15-Apr-15 26-Apr-15 20-Apr-15 30-Apr-15 0% 0% -4.00
DHCWA78120Core Wall - L81 3.00 15-Apr-15 18-Apr-15 20-Apr-15 22-Apr-15 0% 0% -4.00
DHSLA811000Construction of Horizontals - L81 3.00 21-Apr-15 23-Apr-15 26-Apr-15 28-Apr-15 0% 0% -4.00
DHCWA78130Construction of Verticals - L81 2.00 25-Apr-15 26-Apr-15 29-Apr-15 30-Apr-15 0% 0% -4.00
STAIRCASES 25.00 04-Jun-15 02-Jul-15 09-Jun-15 07-Jul-15 0% 0% 15.00
2014 2015 2016 2017
Stair # 2
Stair # 1
Core Wall - L76
Construction of Horizontals - L76
Construction of Verticals - L76
Stair # 2
Stair # 1
Core Wall - L77
Construction of Horizontals - L77
Construction of Verticals - L77
Stair # 2
Stair # 1
Tower Crane Jump
Core Wall - L78
Construction of Horizontals - L78
Construction of Verticals - L78
Stair # 2
Stair # 1
Core Wall - L79
Construction of Horizontals - L79
Construction of Verticals - L79
Stair # 2
Stair # 1
Core Wall - Level 80
Construction of Horizontals - L80
Construction of Verticals - L80
Stair # 2
Stair # 1
Core Wall - L81
Construction of Horizontals - L81
Construction of Verticals - L81
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 16 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
A2900 Stair # 2 3.00 04-Jun-15 07-Jun-15 09-Jun-15 11-Jun-15 0% 0% 37.00
A2890 Stair # 1 4.00 29-Jun-15 02-Jul-15 04-Jul-15 07-Jul-15 0% 0% 7.00
LEVEL 82 68.00 19-Apr-15 07-Jul-15 23-Apr-15 12-Jul-15 0% 0% 14.00
STRUCTURAL WORKS - LEVEL 82 10.00 19-Apr-15 29-Apr-15 23-Apr-15 04-May-15 0% 0% -4.00
DHCWA79150Tower Crane Jump 1.00 19-Apr-15 19-Apr-15 23-Apr-15 23-Apr-15 0% 0% -2.00
DHCWA79120Core Wall - L82 3.00 19-Apr-15 21-Apr-15 23-Apr-15 26-Apr-15 0% 0% -4.00
DHSLA821000Construction of Horizontals - L82 3.00 25-Apr-15 27-Apr-15 29-Apr-15 02-May-15 0% 0% -4.00
DHCWA79130Construction of Verticals - L82 2.00 28-Apr-15 29-Apr-15 03-May-15 04-May-15 0% 0% -4.00
STAIRCASES 26.00 08-Jun-15 07-Jul-15 13-Jun-15 12-Jul-15 0% 0% 14.00
A2920 Stair # 2 3.00 08-Jun-15 10-Jun-15 13-Jun-15 15-Jun-15 0% 0% 37.00
A2910 Stair # 1 4.00 04-Jul-15 07-Jul-15 08-Jul-15 12-Jul-15 0% 0% 7.00
LEVEL 83 69.00 22-Apr-15 12-Jul-15 27-Apr-15 16-Jul-15 0% 0% 13.00
STRUCTURAL WORKS - LEVEL 83 10.00 22-Apr-15 03-May-15 27-Apr-15 07-May-15 0% 0% -4.00
DHCWA80120Core Wall - L83 3.00 22-Apr-15 25-Apr-15 27-Apr-15 29-Apr-15 0% 0% -4.00
DHSLA831000Construction of Horizontals - L83 2.00 29-Apr-15 30-Apr-15 04-May-15 05-May-15 0% 0% -4.00
DHCWA80130Construction of Verticals - L83 2.00 02-May-15 03-May-15 06-May-15 07-May-15 0% 0% -4.00
STAIRCASES 27.00 11-Jun-15 12-Jul-15 16-Jun-15 16-Jul-15 0% 0% 13.00
A2940 Stair # 2 3.00 11-Jun-15 14-Jun-15 16-Jun-15 18-Jun-15 0% 0% 37.00
A2930 Stair # 1 4.00 08-Jul-15 12-Jul-15 13-Jul-15 16-Jul-15 0% 0% 7.00
LEVEL 84 70.00 26-Apr-15 16-Jul-15 30-Apr-15 23-Jul-15 0% 0% 12.00
STRUCTURAL WORKS - LEVEL 84 10.00 26-Apr-15 06-May-15 30-Apr-15 11-May-15 0% 0% -4.00
DHCWA81150Core Wall - Level 84 4.00 26-Apr-15 29-Apr-15 30-Apr-15 04-May-15 0% 0% -4.00
DHSLA841000Construction of Horizontals - L84 2.00 03-May-15 04-May-15 07-May-15 09-May-15 0% 0% -4.00
DHCWA81160Construction of Verticals - L84 2.00 05-May-15 06-May-15 10-May-15 11-May-15 0% 0% -4.00
STAIRCASES 28.00 15-Jun-15 16-Jul-15 20-Jun-15 23-Jul-15 0% 0% 12.00
A2960 Stair # 2 3.00 15-Jun-15 17-Jun-15 20-Jun-15 22-Jun-15 0% 0% 37.00
A2950 Stair # 1 4.00 13-Jul-15 16-Jul-15 20-Jul-15 23-Jul-15 0% 0% 7.00
LEVEL 85(MECHANICAL FLOOR) 70.00 30-Apr-15 23-Jul-15 05-May-15 28-Jul-15 0% 0% 12.00
LEVEL 85 70.00 30-Apr-15 23-Jul-15 05-May-15 28-Jul-15 0% 0% 12.00
STRUCTURAL WORKS - LEVEL 85 8.00 30-Apr-15 09-May-15 05-May-15 13-May-15 0% 0% -4.00
DHCWA81170Tower Crane Jump 1.00 30-Apr-15 30-Apr-15 05-May-15 05-May-15 0% 0% 0.00
DHCWA81120Core Wall - Level 85 4.00 30-Apr-15 04-May-15 05-May-15 09-May-15 0% 0% -4.00
DHSLA851000Construction of Horizontals - L85(Mech Floor) 4.00 04-May-15 07-May-15 09-May-15 12-May-15 0% 0% -4.00
DHCWA81130Construction of Verticals - L85 (Mech Floor) 1.00 09-May-15 09-May-15 13-May-15 13-May-15 0% 0% -4.00
STAIRCASES 29.00 18-Jun-15 23-Jul-15 23-Jun-15 28-Jul-15 0% 0% 12.00
A2810 Stair # 2 4.00 18-Jun-15 22-Jun-15 23-Jun-15 27-Jun-15 0% 0% 37.00
A2800 Stair # 1 4.00 20-Jul-15 23-Jul-15 25-Jul-15 28-Jul-15 0% 0% 7.00
LEVEL 86 TO ROOF 82.00 06-May-15 12-Aug-15 11-May-15 17-Aug-15 0% 0% 7.00
LEVEL 86 66.00 10-May-15 28-Jul-15 14-May-15 02-Aug-15 0% 0% 12.00
STRUCTURAL WORKS - LEVEL 86 3.00 10-May-15 12-May-15 14-May-15 18-May-15 0% 0% -4.00
DHSLA861000Construction of Horizontals - L86 2.00 10-May-15 11-May-15 14-May-15 17-May-15 0% 0% -4.00
DHCWA81140Construction of Verticals - L86 1.00 12-May-15 12-May-15 18-May-15 18-May-15 0% 0% -4.00
STAIRCASES 29.00 23-Jun-15 28-Jul-15 28-Jun-15 02-Aug-15 0% 0% 12.00
A2830 Stair # 2 4.00 23-Jun-15 27-Jun-15 28-Jun-15 01-Jul-15 0% 0% 37.00
A2820 Stair # 1 4.00 25-Jul-15 28-Jul-15 29-Jul-15 02-Aug-15 0% 0% 7.00
ROOF & TOP OF ROOF 82.00 06-May-15 12-Aug-15 11-May-15 17-Aug-15 0% 0% 7.00
STRUCTURAL WORKS - LEVEL 87 & Above 8.00 06-May-15 14-May-15 11-May-15 20-May-15 0% 0% -4.00
DHCWA82100Core Wall - Level RF,URF 4.00 06-May-15 10-May-15 11-May-15 14-May-15 0% 0% -4.00
DHSLA871000Construction of Roof Deck Slab L87 1.00 13-May-15 13-May-15 19-May-15 19-May-15 0% 0% -4.00
2014 2015 2016 2017
Stair # 2
Stair # 1
Tower Crane Jump
Core Wall - L82
Construction of Horizontals - L82
Construction of Verticals - L82
Stair # 2
Stair # 1
Core Wall - L83
Construction of Horizontals - L83
Construction of Verticals - L83
Stair # 2
Stair # 1
Core Wall - Level 84
Construction of Horizontals - L84
Construction of Verticals - L84
Stair # 2
Stair # 1
Tower Crane Jump
Core Wall - Level 85
Construction of Horizontals - L85(Mech Floor)
Construction of Verticals - L85 (Mech Floor)
Stair # 2
Stair # 1
Construction of Horizontals - L86
Construction of Verticals - L86
Stair # 2
Stair # 1
Core Wall - Level RF,URF
Construction of Roof Deck Slab L87
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 17 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
Activity ID Activity Name Current
Duration
Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned %
Complete
Actual %
Complete
Total
Float
M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F
DHSLA881000Construction of Top of Roof Slab-L88 2.00 13-May-15 14-May-15 19-May-15 20-May-15 0% 0% -4.00
STAIRCASES 38.00 28-Jun-15 12-Aug-15 02-Jul-15 17-Aug-15 0% 0% 7.00
A2850 Stair # 2 4.00 28-Jun-15 01-Jul-15 02-Jul-15 06-Jul-15 0% 0% 37.00
A2840 Stair # 1 4.00 09-Aug-15 12-Aug-15 13-Aug-15 17-Aug-15 0% 0% 7.00
2014 2015 2016 2017
Construction of Top of Roof Slab-L88
Stair # 2
Stair # 1
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Data Date : 30-Sep-14
Page : 18 of 18
Printed On : 16-Oct-14
Baseline
Actual Work
Remaining Work
Critical Remaining Work
Baseline Milestone
Curernt Milestone
Damac Heights Tower at Dubai Marina
Project Progress Update as of 30-Sep-2014
Delay in the Structure[
Date Revision Checked Approved
20-Aug... Target Completion Programme - Rev 03 (Basel...
30-Sep... Schedule Update - September-14 (Update) SK
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 3
Core Walls and Slabs
Cycles
Gain/Loss (Days) Gain/Loss (Days) Gain/Loss (Days)
Total Last Period Current Week
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Core Wal - L06 6 15-Feb-14 20-Feb-14 0 - 20-Feb-14 - -
Core Wal - L07 9 20-Feb-14 5-Mar-14 0 13.00 28-Feb-14 8.00 5.00 5.00
Core Wal - L08 9 6-Mar-14 16-Mar-14 0 11.00 11-Mar-14 11.00 - -
Weekly
Movement
Planned Actual / Forecast Progress Analysis
Core Walls Cycles
Core Wall Levels Original Duration Planned Start
Date
Planned Finish
Date
Total
Float Critical Planned
Cycle Actual Finish Date Actual Cycle Forecast Finish Date
Core Wall - L09 10 17-Mar-14 27-Mar-14 0 11.00 23-Mar-14 12.00 (1.00) (1.00)
Core Wall - L10 4 29-Mar-14 1-Apr-14 0 5.00 31-Mar-14 8.00 (3.00) (3.00)
Core Wall - L11 4 2-Apr-14 6-Apr-14 0 5.00 8-Apr-14 8.00 (3.00) (3.00)
Core Wall - L12 6 7-Apr-14 13-Apr-14 0 7.00 14-Apr-14 6.00 1.00 1.00
Core Wall - L13 4 14-Apr-14 17-Apr-14 0 4.00 20-Apr-14 6.00 (2.00) (2.00)
Core Wall - L14 4 19-Apr-14 22-Apr-14 0 5.00 27-Apr-14 7.00 (2.00) (2.00)
Core Wall - L15 9 23-Apr-14 3-May-14 0 11.00 5-May-14 8.00 3.00 3.00
Core Wall - L16 5 4-May-14 8-May-14 0 5.00 8-May-14 3.00 2.00 2.00
Core Wall - L17 5 10-May-14 14-May-14 0 6.00 14-May-14 6.00 - -
Core Wall - L18 5 15-May-14 20-May-14 0 6.00 19-May-14 5.00 1.00 1.00
Core Wall - L19 5 21-May-14 26-May-14 0 6.00 26-May-14 7.00 (1.00) (1.00)
Core Wall - L20 4 28-May-14 1-Jun-14 0 6.00 31-May-14 5.00 1.00 1.00
Core Wall - L21 4 2-Jun-14 5-Jun-14 0 4.00 6-Jun-14 6.00 (2.00) (2.00)
Core Wall - L 22 4 12-Jun-14 16-Jun-14 0 11.00 10-Jun-14 4.00 7.00 7.00
Core Wall - L23 4 17-Jun-14 21-Jun-14 0 5.00 15-Jun-14 5.00 - -
Core Wall - L24 8 22-Jun-14 30-Jun-14 0 9.00 19-Jun-14 4.00 5.00 5.00
Core Wall - L25 5 1-Jul-14 6-Jul-14 0 6.00 26-Jun-14 7.00 (1.00) (1.00)
Core Wall - L26 6 7-Jul-14 13-Jul-14 0 7.00 3-Jul-14 7.00 - -
Core Wall - L27 6 14-Jul-14 20-Jul-14 0 7.00 14-Jul-14 11.00 (4.00) (4.00)
Core Wall - L28 6 21-Jul-14 27-Jul-14 0 7.00 21-Jul-14 7.00 - -
Core Wall - L29 5 30-Jul-14 4-Aug-14 0 8.00 27-Jul-14 6.00 2.00 2.00
Core Wall - L30 6 5-Aug-14 11-Aug-14 0 7.00 13-Aug-14 17.00 (10.00) (10.00)
Core Wall - L31 6 12-Aug-14 18-Aug-14 0 7.00 17-Aug-14 4.00 3.00 3.00
Core Wall - L32 4 19-Aug-14 23-Aug-14 0 5.00 24-Aug-14 7.00 (2.00) (2.00)
Core Wall - L33 5 24-Aug-14 28-Aug-14 0 5.00 28-Aug-14 4.00 1.00 1.00
Core Wall - L34 5 30-Aug-14 3-Sep-14 0 6.00 3-Sep-14 6.00 - -
Core Wall - L35 4 4-Sep-14 8-Sep-14 0 5.00 14-Sep-14 11.00 (6.00) (6.00)
Core Wall - L36 7 9-Sep-14 16-Sep-14 0 8.00 17-Sep-14 3.00 5.00 5.00
Core Wall - L37 5 17-Sep-14 22-Sep-14 0 6.00 25-Sep-14 8.00 (2.00) (2.00)
Core Wall - L38 4 23-Sep-14 27-Sep-14 0 5.00 29-Sep-14 4.00 1.00 1.00
Core Wall - L39 4 28-Sep-14 1-Oct-14 0 4.00 3-Oct-14
Core Wall - L40 4 2-Oct-14 8-Oct-14 0 7.00 10-Oct-14
Core Wall - L41 4 9-Oct-14 13-Oct-14 0 5.00 15-Oct-14
Core Wall - L42 5 14-Oct-14 19-Oct-14 0 6.00 21-Oct-14
Core Wall - L43 4 20-Oct-14 23-Oct-14 0 4.00 25-Oct-14
Core Wall - L44 4 26-Oct-14 29-Oct-14 0 6.00 31-Oct-14
Core Wall - L45 4 30-Oct-14 3-Nov-14 0 5.00 5-Nov-14
Core Wall - L46 5 4-Nov-14 9-Nov-14 0 6.00 11-Nov-14
Core Wall - L47 5 10-Nov-14 15-Nov-14 0 6.00 17-Nov-14
Core Wall - L48 4 16-Nov-14 19-Nov-14 0 4.00 21-Nov-14
Core Wall - L49 4 20-Nov-14 24-Nov-14 0 5.00 26-Nov-14
Gain/Loss (Days) Gain/Loss (Days) Gain/Loss (Days)
Total Last Period Current Week
Weekly
Movement
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Planned Actual / Forecast Progress Analysis
Core Walls Cycles
Core Wall Levels Original Duration Planned Start
Date
Planned Finish
Date
Total
Float Critical Planned
Cycle Actual Finish Date Actual Cycle Forecast Finish Date
Core Wall - L50 4 25-Nov-14 29-Nov-14 0 5.00 1-Dec-14
Core Wall - L51 4 30-Nov-14 4-Dec-14 0 5.00 6-Dec-14
Core Wall - L52 4 6-Dec-14 9-Dec-14 0 5.00 11-Dec-14
Core Wall - L53 4 10-Dec-14 14-Dec-14 0 5.00 16-Dec-14
Core Wall - L54 4 15-Dec-14 18-Dec-14 0 4.00 20-Dec-14
Core Wall - L55 4 20-Dec-14 23-Dec-14 0 5.00 25-Dec-14
Core Wall - L56 4 24-Dec-14 28-Dec-14 0 5.00 30-Dec-14
Core Wall - L57 3 29-Dec-14 31-Dec-14 0 3.00 2-Jan-15
Core Wall - L58 3 3-Jan-15 5-Jan-15 0 5.00 7-Jan-15
Core Wall - L59 4 6-Jan-15 10-Jan-15 0 5.00 12-Jan-15
Core Wall - L 60 3 11-Jan-15 13-Jan-15 0 3.00 15-Jan-15
Core Wall - L61 3 14-Jan-15 17-Jan-15 0 4.00 19-Jan-15
Core Wall - L62 6 18-Jan-15 24-Jan-15 0 7.00 26-Jan-15
Core Wall - L63 3 25-Jan-15 27-Jan-15 0 3.00 29-Jan-15
Core Wall - L64 5 28-Jan-15 2-Feb-15 0 6.00 4-Feb-15
Core Wall - L65 5 3-Feb-15 8-Feb-15 0 6.00 10-Feb-15
Core Wall - L66 5 9-Feb-15 14-Feb-15 0 6.00 16-Feb-15
Core Wall - L67 4 15-Feb-15 18-Feb-15 0 4.00 20-Feb-15
Core Wall - L68 4 19-Feb-15 23-Feb-15 0 5.00 25-Feb-15
Core Wall - L69 4 24-Feb-15 28-Feb-15 0 5.00 2-Mar-15
Core Wall - L70 5 1-Mar-15 5-Mar-15 0 5.00 7-Mar-15
Core Wall - L71 4 7-Mar-15 10-Mar-15 0 5.00 12-Mar-15
Core Wall - L72 4 11-Mar-15 15-Mar-15 0 5.00 17-Mar-15
Core Wall - L73 4 16-Mar-15 19-Mar-15 0 4.00 21-Mar-15
Core Wall - L74 4 21-Mar-15 24-Mar-15 0 5.00 26-Mar-15
Core Wall - L75 3 25-Mar-15 28-Mar-15 0 4.00 30-Mar-15
Core Wall - L76 3 29-Mar-15 31-Mar-15 0 3.00 2-Apr-15
Core Wall - L77 3 1-Apr-15 4-Apr-15 0 4.00 6-Apr-15
Core Wall - L78 3 5-Apr-15 7-Apr-15 0 3.00 9-Apr-15
Core Wall - L79 3 8-Apr-15 11-Apr-15 0 4.00 13-Apr-15
Core Wall - Level 80 3 12-Apr-15 14-Apr-15 0 3.00 16-Apr-15
Core Wall - L81 3 15-Apr-15 18-Apr-15 0 4.00 20-Apr-15
Core Wall - L82 3 19-Apr-15 21-Apr-15 0 3.00 23-Apr-15
Core Wall - L83 3 22-Apr-15 25-Apr-15 0 4.00 27-Apr-15
Core Wall - Level 84 4 26-Apr-15 29-Apr-15 0 4.00 1-May-15
Core Wall - Level 85 4 30-Apr-15 4-May-15 0 5.00 6-May-15
Core Wall - Level RF,URF 4 6-May-15 10-May-15 0 6.00 12-May-15
Grand Total 10-May-15 12-May-15 (2.00) (1.00) (1.00)
Notes Legend
**This Analysis was run using the Target Completion Programme (TCP) - Rev 03. Behind the Planned Cycle
Achieved the Planned Cycle
Ahead of the Planned Cycle
Gain/Loss (Days) Gain/Loss (Days) Gain/Loss (Days)
Total Last Period Current Week
Planned Actual / Forecast Progress Analysis
Construction of Horizontals - L06 4 10-Mar-14 11-Mar-14 0 - 4-Mar-14 7.00 7.00
Construction of Horizontals - L07 4 17-Mar-14 20-Mar-14 0 9.00 16-Mar-14 12.00 (3.00) (3.00)
Construction of Horizontals - L08 4 24-Mar-14 27-Mar-14 0 7.00 25-Mar-14 9.00 (2.00) (2.00)
Weekly
Movement
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Slabs Cycles
Slab Levels Original Duration Planned Start
Date
Planned Finish
Date
Total
Float Critical Planned
Cycle Actual Finish Date Actual Cycle Forecast Finish Date
Construction of Horizontals - L09 4 31-Mar-14 3-Apr-14 0 7.00 3-Apr-14 9.00 (2.00) (2.00)
Construction of Horizontals - L10 4 7-Apr-14 10-Apr-14 0 7.00 10-Apr-14 7.00 - -
Construction of Horizontals - L11 4 14-Apr-14 17-Apr-14 0 7.00 17-Apr-14 7.00 - -
Construction of Horizontals - L12 4 21-Apr-14 24-Apr-14 0 7.00 24-Apr-14 7.00 - -
Construction of Horizontals - L13 3 28-Apr-14 30-Apr-14 0 6.00 30-Apr-14 6.00 - -
Construction of Horizontals - L14 3 4-May-14 6-May-14 0 6.00 8-May-14 8.00 (2.00) (2.00)
Construction of Horizontals - L15 3 10-May-14 12-May-14 0 6.00 15-May-14 7.00 (1.00) (1.00)
Construction of Horizontals- L16 3 15-May-14 18-May-14 0 6.00 20-May-14 5.00 1.00 1.00
Construction of Horizontals - L17 3 21-May-14 24-May-14 0 6.00 27-May-14 7.00 (1.00) (1.00)
Construction of Horizontals - L18 3 29-May-14 1-Jun-14 0 8.00 3-Jun-14 7.00 1.00 1.00
Construction of Horizontals - L19 3 4-Jun-14 7-Jun-14 0 6.00 9-Jun-14 6.00 - -
Construction of Horizontals - L20 3 10-Jun-14 12-Jun-14 0 5.00 14-Jun-14 5.00 - -
Construction of Horizontals - L21 3 16-Jun-14 18-Jun-14 0 6.00 21-Jun-14 7.00 (1.00) (1.00)
Construction of Horizontals - L22 3 22-Jun-14 24-Jun-14 0 6.00 27-Jun-14 6.00 - -
Construction of Horizontals- L23 5 28-Jun-14 2-Jul-14 0 8.00 4-Jul-14 7.00 1.00 1.00
Construction of Horizontals - L24 4 7-Jul-14 10-Jul-14 0 8.00 10-Jul-14 6.00 2.00 2.00
Construction of Horizontals - L25 4 15-Jul-14 19-Jul-14 0 9.00 17-Jul-14 7.00 2.00 2.00
Construction of Horizontals - L26 4 22-Jul-14 26-Jul-14 0 7.00 23-Jul-14 6.00 1.00 1.00
Construction of Horizontals - L27 3 31-Jul-14 3-Aug-14 0 8.00 1-Aug-14 9.00 (1.00) (1.00)
Construction of Horizontals - L28 3 6-Aug-14 9-Aug-14 0 6.00 9-Aug-14 8.00 (2.00) (2.00)
Construction of Horizontals - L29 3 13-Aug-14 16-Aug-14 0 7.00 14-Aug-14 5.00 2.00 2.00
Construction of Horizontals - L30 (M) 3 20-Aug-14 23-Aug-14 0 7.00 22-Aug-14 8.00 (1.00) (1.00)
Construction of Horizontals - L31 4 27-Aug-14 31-Aug-14 0 8.00 31-Aug-14 9.00 (1.00) (1.00)
Construction of Horizontals - L32 4 2-Sep-14 6-Sep-14 0 6.00 7-Sep-14 7.00 (1.00) (1.00)
Construction of Horizontals - L33 4 8-Sep-14 11-Sep-14 0 5.00 12-Sep-14 5.00 - -
Construction of Horizontals - L34 4 13-Sep-14 16-Sep-14 0 5.00 18-Sep-14 6.00 (1.00) (1.00)
Construction of Horizontals - L35 4 17-Sep-14 21-Sep-14 0 5.00 24-Sep-14 6.00 (1.00) (1.00)
Construction of Horizontals - L36 4 23-Sep-14 27-Sep-14 0 6.00 30-Sep-14 6.00 - -
Construction of Horizontals - L37 4 29-Sep-14 2-Oct-14 1 5.00 5-Oct-14
Construction of Horizontals - L38 3 6-Oct-14 8-Oct-14 1 6.00 11-Oct-14
Construction of Horizontals - L39 4 9-Oct-14 13-Oct-14 1 5.00 16-Oct-14
Construction of Horizontals - L40 4 14-Oct-14 18-Oct-14 1 5.00 21-Oct-14
Construction of Horizontals - L41 4 20-Oct-14 23-Oct-14 1 5.00 26-Oct-14
Construction of Horizontals - L42 4 26-Oct-14 29-Oct-14 0 6.00 1-Nov-14
Construction of Horizontals - L43 4 1-Nov-14 4-Nov-14 0 6.00 7-Nov-14
Construction of Horizontals - L44 4 5-Nov-14 9-Nov-14 0 5.00 12-Nov-14
Construction of Horizontals - L45 4 11-Nov-14 15-Nov-14 0 6.00 18-Nov-14
Construction of Horizontals - L46 4 17-Nov-14 20-Nov-14 0 5.00 23-Nov-14
Construction of Horizontals - L47 4 22-Nov-14 25-Nov-14 0 5.00 28-Nov-14
Construction of Horizontals - L48 4 26-Nov-14 30-Nov-14 0 5.00 3-Dec-14
Construction of Horizontals - L49 4 30-Nov-14 4-Dec-14 0 4.00 7-Dec-14
Gain/Loss (Days) Gain/Loss (Days) Gain/Loss (Days)
Total Last Period Current Week
Planned Actual / Forecast Progress Analysis
Weekly
Movement
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Slabs Cycles
Slab Levels Original Duration Planned Start
Date
Planned Finish
Date
Total
Float Critical Planned
Cycle Actual Finish Date Actual Cycle Forecast Finish Date
Construction of Horizontals - L50 4 6-Dec-14 9-Dec-14 0 5.00 12-Dec-14
Construction of Horizontals - L51 4 10-Dec-14 14-Dec-14 0 5.00 17-Dec-14
Construction of Horizontals - L52 4 15-Dec-14 18-Dec-14 0 4.00 21-Dec-14
Construction of Horizontals - L53 4 20-Dec-14 23-Dec-14 0 5.00 26-Dec-14
Construction of Horizontals - L54 4 23-Dec-14 27-Dec-14 0 4.00 30-Dec-14
Construction of Horizontals - L55 3 29-Dec-14 31-Dec-14 0 4.00 3-Jan-15
Construction of Horizontals - L56 3 4-Jan-15 6-Jan-15 0 6.00 9-Jan-15
Construction of Horizontals - L57 4 6-Jan-15 10-Jan-15 0 4.00 13-Jan-15
Construction of Horizontals - L58 4 11-Jan-15 14-Jan-15 0 4.00 17-Jan-15
Construction of Horizontals - L59 3 15-Jan-15 18-Jan-15 0 4.00 21-Jan-15
Construction of Horizontal - L60 3 20-Jan-15 22-Jan-15 0 4.00 25-Jan-15
Construction of Horizontal - L61 3 24-Jan-15 26-Jan-15 0 4.00 29-Jan-15
Construction of Horizontal - L62 ( M ) 5 29-Jan-15 3-Feb-15 0 8.00 6-Feb-15
Construction of Horizontal - L63 4 8-Feb-15 11-Feb-15 0 8.00 14-Feb-15
Construction of Horizontal - L64 3 12-Feb-15 15-Feb-15 1 4.00 18-Feb-15
Construction of Horizontals - L65 3 17-Feb-15 19-Feb-15 1 4.00 22-Feb-15
Construction of Horizontals - L66 3 22-Feb-15 24-Feb-15 1 5.00 27-Feb-15
Construction of Horizontals - L67 3 25-Feb-15 28-Feb-15 1 4.00 3-Mar-15
Construction of Horizontals - L68 3 2-Mar-15 4-Mar-15 1 4.00 7-Mar-15
Construction of Horizontals - L69 3 7-Mar-15 9-Mar-15 2 5.00 12-Mar-15
Construction of Horizontals - L70 3 10-Mar-15 12-Mar-15 2 3.00 15-Mar-15
Construction of Horizontals - L71 3 14-Mar-15 16-Mar-15 2 4.00 19-Mar-15
Construction of Horizontals - L72 3 18-Mar-15 21-Mar-15 1 5.00 24-Mar-15
Construction of Horizontals - L73 3 23-Mar-15 25-Mar-15 0 4.00 28-Mar-15
Construction of Horizontals - L74 3 26-Mar-15 29-Mar-15 0 4.00 1-Apr-15
Construction of Horizontals - L75 3 30-Mar-15 1-Apr-15 0 3.00 4-Apr-15
Construction of Horizontals - L76 3 2-Apr-15 5-Apr-15 0 4.00 8-Apr-15
Construction of Horizontals - L77 3 6-Apr-15 8-Apr-15 0 3.00 11-Apr-15
Construction of Horizontals - L78 3 9-Apr-15 12-Apr-15 0 4.00 15-Apr-15
Construction of Horizontals - L79 3 13-Apr-15 15-Apr-15 0 3.00 18-Apr-15
Construction of Horizontals - L80 3 18-Apr-15 20-Apr-15 0 5.00 23-Apr-15
Construction of Horizontals - L81 3 21-Apr-15 23-Apr-15 0 3.00 26-Apr-15
Construction of Horizontals - L82 3 25-Apr-15 27-Apr-15 0 4.00 30-Apr-15
Construction of Horizontals - L83 2 29-Apr-15 30-Apr-15 0 3.00 3-May-15
Construction of Horizontals - L84 2 3-May-15 4-May-15 0 4.00 7-May-15
Construction of Horizontals - L85 (M) 4 4-May-15 7-May-15 0 3.00 10-May-15
Construction of Horizontals - L86 2 10-May-15 11-May-15 0 4.00 14-May-15
Construction of Roof Deck Slab L87 1 13-May-15 13-May-15 0 2.00 16-May-15
Construction of Top of Roof Slab-L88 2 13-May-15 14-May-15 0 1.00 17-May-15
Grand Total 14-May-15 17-May-15 (3.00) (2.00) (1.00)
Notes Legend
**This Analysis was run using the Target Completion Programme (TCP) - Rev 03. Behind the Planned Cycle
** According to TCP-Rev 03, The Target Completion Date for Tower Structure is 14-May-15. Achieved the Planned Cycle
Ahead of the Planned Cycle
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 4
MEP Progress
Floor
Pipes
Support
Fixing
Inst. of CW
Horizontal
Pipes
CW
Pipe
Test
CW Pipe
Final
Insulation
Ducts
Support
Fixing
Duct
Fabric.
Instal. of
Ducts &
Insulation
Volume, Fire,
Smoke, NR
Dampers
Fixing
Inst. of
CW
Riser
Pipes
CW
Riser
Test
Inst. of
Ducts
Risers
Ducts
Risers
Test
Inst. of
Fan
Coil
Units
FCU
Connection
(Duct/Pipe)
FCU
Drain
Pipe
Inst. of
Valves &
Acces.
Inst. of
Flexible
Ducts
Access
Panels
Inst. of
Plenum
Boxes
Inst. of
Grilles&
Diffusers
Kitchen
Exhaust
Fan Fixing
Thermostat
Fixing
HVAC Work Progress
Shaft
Works
(10%)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
CW Pipes Ducts Final
Fix
(10%)
Works with FC
Grids
Final Fix
Works Prior to False Ceiling
Clearence
Works
with
FC
Grids
(10%)
Works
Prior to
FC
Clearence
(20%)
HL Works Prior to Blocks
HL Works
Prior to
Blocks
(50%)
Chilled Water Pipes
Shaft Works
Ducts
B5 80% 80% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30% 26% 0% 0% 0%
B4 80% 80% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30% 26% 0% 0% 0%
B3 80% 80% 0% 0% 50% 50% 50% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59% 26% 0% 0% 0%
B2 80% 80% 0% 0% 60% 50% 50% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59% 26% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26% 0% 0% 0%
G 0% 0% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 60% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 100% 100% 100% 100% 100% 100% 100% 100% 70% 0% 100% 0% 100% 100% 100% 95% 95% 0% 95% 0% 0% 0% 100% 70% 100% 76% 0%
7th 100% 100% 100% 100% 100% 100% 100% 100% 70% 0% 100% 0% 100% 100% 98% 95% 95% 0% 95% 0% 0% 0% 100% 70% 99% 76% 0%
8th 100% 100% 97% 97% 100% 100% 100% 100% 70% 0% 100% 0% 100% 95% 95% 95% 0% 0% 95% 0% 0% 0% 100% 70% 99% 38% 0%
9th 100% 100% 97% 97% 98% 98% 98% 98% 70% 0% 100% 0% 100% 95% 95% 95% 0% 0% 0% 0% 0% 0% 99% 70% 99% 0% 0%
10th 100% 100% 97% 80% 98% 98% 98% 98% 70% 0% 100% 0% 100% 80% 95% 95% 0% 0% 0% 0% 0% 0% 99% 70% 97% 0% 0%
11th 95% 95% 95% 0% 98% 98% 98% 98% 60% 0% 100% 0% 100% 0% 20% 95% 0% 0% 0% 0% 0% 0% 96% 67% 82% 0% 0%
12th 95% 95% 60% 0% 98% 98% 98% 98% 60% 0% 100% 0% 95% 0% 0% 45% 0% 0% 0% 0% 0% 0% 96% 67% 71% 0% 0%
13th 95% 95% 0% 0% 98% 98% 98% 98% 60% 0% 100% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 67% 67% 0% 0%
14th 95% 95% 95% 0% 98% 98% 98% 98% 60% 0% 100% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 67% 67% 0% 0%
15th 95% 95% 95% 0% 98% 98% 98% 98% 60% 0% 100% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 67% 67% 0% 0%
16th 95% 95% 95% 0% 98% 98% 98% 98% 60% 0% 100% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 67% 67% 0% 0%
17th 95% 95% 95% 0% 98% 98% 98% 98% 60% 0% 100% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 67% 67% 0% 0%
18th 95% 95% 95% 0% 98% 98% 98% 98% 0% 0% 98% 0% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 47% 70% 0% 0%
19th 95% 95% 60% 0% 98% 98% 98% 98% 0% 0% 70% 0% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 34% 70% 0% 0%
20th 95% 95% 0% 0% 98% 98% 98% 98% 0% 0% 70% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 34% 67% 0% 0%
21st 95% 95% 60% 0% 98% 98% 98% 98% 0% 0% 70% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 34% 67% 0% 0%
22nd 95% 95% 0% 0% 98% 98% 98% 98% 0% 0% 30% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 14% 67% 0% 0%
23rd 95% 95% 0% 0% 98% 98% 98% 98% 0% 0% 0% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 67% 0% 0%
24th 95% 95% 60% 0% 95% 95% 90% 80% 0% 0% 0% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 91% 0% 67% 0% 0%
25th 95% 95% 0% 0% 95% 95% 90% 85% 0% 0% 0% 0% 30% 0% 0% 0% 0% 0% 0% 0% 0% 0% 90% 0% 21% 0% 0%
26th 95% 95% 0% 0% 90% 95% 90% 60% 0% 0% 0% 0% 10% 0% 0% 0% 0% 0% 0% 0% 0% 0% 90% 0% 7% 0% 0%
27th 95% 95% 0% 0% 90% 90% 80% 40% 0% 0% 0% 0% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84% 0% 70% 0% 0%
28th 70% 70% 0% 0% 90% 90% 70% 20% 0% 0% 0% 0% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69% 0% 70% 0% 0%
29th 70% 70% 0% 0% 50% 70% 40% 10% 0% 0% 0% 0% 90% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52% 0% 63% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. MEP Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 2:35 PM
Floor
Pipes
Support
Fixing
Inst. of CW
Horizontal
Pipes
CW
Pipe
Test
CW Pipe
Final
Insulation
Ducts
Support
Fixing
Duct
Fabric.
Instal. of
Ducts &
Insulation
Volume, Fire,
Smoke, NR
Dampers
Fixing
Inst. of
CW
Riser
Pipes
CW
Riser
Test
Inst. of
Ducts
Risers
Ducts
Risers
Test
Inst. of
Fan
Coil
Units
FCU
Connection
(Duct/Pipe)
FCU
Drain
Pipe
Inst. of
Valves &
Acces.
Inst. of
Flexible
Ducts
Access
Panels
Inst. of
Plenum
Boxes
Inst. of
Grilles&
Diffusers
Kitchen
Exhaust
Fan Fixing
Thermostat
Fixing
HVAC Work Progress
Shaft
Works
(10%)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
CW Pipes Ducts Final
Fix
(10%)
Works with FC
Grids
Final Fix
Works Prior to False Ceiling
Clearence
Works
with
FC
Grids
(10%)
Works
Prior to
FC
Clearence
(20%)
HL Works Prior to Blocks
HL Works
Prior to
Blocks
(50%)
Chilled Water Pipes
Shaft Works
Ducts
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. MEP Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 2:35 PM
Floor
Pipes
Support
Fixing
Inst. of CW
Horizontal
Pipes
CW
Pipe
Test
CW Pipe
Final
Insulation
Ducts
Support
Fixing
Duct
Fabric.
Instal. of
Ducts &
Insulation
Volume, Fire,
Smoke, NR
Dampers
Fixing
Inst. of
CW
Riser
Pipes
CW
Riser
Test
Inst. of
Ducts
Risers
Ducts
Risers
Test
Inst. of
Fan
Coil
Units
FCU
Connection
(Duct/Pipe)
FCU
Drain
Pipe
Inst. of
Valves &
Acces.
Inst. of
Flexible
Ducts
Access
Panels
Inst. of
Plenum
Boxes
Inst. of
Grilles&
Diffusers
Kitchen
Exhaust
Fan Fixing
Thermostat
Fixing
HVAC Work Progress
Shaft
Works
(10%)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
CW Pipes Ducts Final
Fix
(10%)
Works with FC
Grids
Final Fix
Works Prior to False Ceiling
Clearence
Works
with
FC
Grids
(10%)
Works
Prior to
FC
Clearence
(20%)
HL Works Prior to Blocks
HL Works
Prior to
Blocks
(50%)
Chilled Water Pipes
Shaft Works
Ducts
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. MEP Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 2:35 PM
Works Prior to False
Ceiling Clearence
Fire Fighting Work Progress
Floor
HL Works Prior to Blocks Shaft Work Works with FC Grids Final Fix
Pipes
Support
Fixing
Inst. of Fire
Fighting Pipes
Fire Pipe Test
and Flushing
Inst. of
Riser
Pipes
Riser
Test
Installation of Zone
Control Valves
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Installation of
Sprinkler
Dropper Pipes
Installation of
Identification
Labels
Installation of
Landing
Valve
Installation of
Sprinkler Heads
Installation of
Sprinkler
Cover
Installation of
Fire Hose Reel
and Cabinet
Installation of
Fire
Extinguishers
HL Works
Prior to
Blocks
(65%)
Works Prior
to FC
Clearence
(5%)
Works with
FC Grids
(10%)
Final Fix
(10%)
Shaft
Works
(10%)
B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B4 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78% 0% 0% 0% 0%
B3 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78% 0% 0% 0% 0%
B2 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 100% 100% 100% 100% 100% 0% 0% 100% 0% 0% 0% 0% 0% 100% 100% 0% 5% 0%
7th 100% 100% 100% 100% 100% 0% 0% 100% 0% 0% 0% 0% 0% 100% 100% 0% 5% 0%
8th 100% 100% 100% 100% 100% 0% 0% 100% 0% 0% 0% 0% 0% 100% 100% 0% 5% 0%
9th 100% 100% 100% 100% 100% 0% 0% 100% 0% 0% 0% 0% 0% 100% 100% 0% 5% 0%
10th 100% 100% 100% 100% 100% 0% 0% 100% 0% 0% 0% 0% 0% 100% 100% 0% 5% 0%
11th 100% 100% 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 100% 100% 0% 0% 0%
12th 100% 100% 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 100% 100% 0% 0% 0%
13th 100% 100% 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 100% 100% 0% 0% 0%
14th 100% 100% 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 100% 100% 0% 0% 0%
15th 100% 100% 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 100% 100% 0% 0% 0%
16th 100% 100% 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 100% 100% 0% 0% 0%
17th 100% 100% 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 100% 100% 0% 0% 0%
18th 100% 100% 100% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 100% 95% 0% 0% 0%
19th 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 0% 0% 0% 0%
20th 100% 100% 60% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 99% 0% 0% 0% 0%
21st 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 0% 0% 0% 0%
22nd 100% 100% 60% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 99% 0% 0% 0% 0%
23rd 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 0% 0% 0% 0%
24th 100% 100% 40% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 99% 0% 0% 0% 0%
25th 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 98% 0% 0% 0% 0%
26th 98% 98% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 0% 0% 0% 0%
27th 98% 98% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 0% 0% 0% 0%
28th 90% 90% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 88% 0% 0% 0% 0%
29th 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. MEP Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 2:35 PM
Works Prior to False
Ceiling Clearence
Floor
Pipes
Support
Fixing
Inst. of Fire
Fighting Pipes
Fire Pipe Test
and Flushing
Inst. of
Riser
Pipes
Riser
Test
Installation of Zone
Control Valves
Installation of
Sprinkler
Dropper Pipes
Installation of
Identification
Labels
Installation of
Landing
Valve
Installation of
Sprinkler Heads
Installation of
Sprinkler
Cover
Installation of
Fire Hose Reel
and Cabinet
Installation of
Fire
Extinguishers
HL Works
Prior to
Blocks
(65%)
Works Prior
to FC
Clearence
(5%)
Works with
FC Grids
(10%)
Final Fix
(10%)
Shaft
Works
(10%)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Fire Fighting Work Progress
HL Works Prior to Blocks Shaft Work Works with FC Grids Final Fix
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. MEP Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 2:35 PM
Works Prior to False
Ceiling Clearence
Floor
Pipes
Support
Fixing
Inst. of Fire
Fighting Pipes
Fire Pipe Test
and Flushing
Inst. of
Riser
Pipes
Riser
Test
Installation of Zone
Control Valves
Installation of
Sprinkler
Dropper Pipes
Installation of
Identification
Labels
Installation of
Landing
Valve
Installation of
Sprinkler Heads
Installation of
Sprinkler
Cover
Installation of
Fire Hose Reel
and Cabinet
Installation of
Fire
Extinguishers
HL Works
Prior to
Blocks
(65%)
Works Prior
to FC
Clearence
(5%)
Works with
FC Grids
(10%)
Final Fix
(10%)
Shaft
Works
(10%)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Fire Fighting Work Progress
HL Works Prior to Blocks Shaft Work Works with FC Grids Final Fix
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. MEP Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 2:35 PM
Floor
Drainage
Pipes
Support
Fixing
Inst. of
Drainage
Pipes &
Fittings
Drainage
Pipes
Test
Water
Pipes
Support
Fixing
Inst. of
Water
Pipes &
Fittings
Inst. Of
Drainage
Pipes
Riser
Drainage
Riser
Test
Inst. Of
Water
Pipes
Riser
WS Riser
Test
Cutting &
Chasing in
Block
Walls
Fixing
Drainage
Pipes in
Block Walls
Drainage
Pipes
Test
Fixing
Water
Pipes in
Block
Water
Pipes
Test
Inst. &
Connection
to Water
Heater
Inst. of
Identification
Labels
Inst. of
Sanitary
ware
Inst. of
Water
Meter
Inst. of
Floor
Drain
Covers
Plumbing Work Progress
HL Works Prior to Blocks
Final Fix
HL Works
Prior to
Blocks
(60%)
Works Prior
to FC
Clearence
(5%)
Final Fix
(15%)
Shaft Works
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Concealed
MEP
Services
(10%)
Drainage Water Supply
Concealed MEP Services
Works Prior to
False Ceiling
Clearence Shaft
Works
(10%)
Drainage Water Supply
Horizontal
Horizontal Walls
B5 40% 40% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22% 0% 0% 0% 0%
B4 40% 40% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22% 0% 0% 0% 0%
B3 45% 45% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24% 0% 0% 0% 0%
B2 40% 40% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 98% 98% 98% 100% 100% 98% 98% 90% 90% 100% 100% 100% 100% 100% 98% 100% 0% 0% 0% 99% 95% 100% 98% 0%
7th 98% 98% 98% 100% 100% 98% 98% 90% 90% 100% 100% 100% 100% 100% 98% 100% 0% 0% 0% 99% 95% 100% 98% 0%
8th 95% 95% 95% 100% 100% 98% 98% 90% 90% 100% 100% 100% 100% 100% 98% 100% 0% 0% 0% 97% 95% 100% 98% 0%
9th 95% 95% 95% 100% 100% 98% 98% 90% 90% 100% 100% 100% 100% 100% 90% 100% 0% 0% 0% 97% 95% 100% 91% 0%
10th 95% 95% 95% 100% 100% 98% 98% 90% 90% 100% 100% 100% 100% 100% 80% 100% 0% 0% 0% 97% 95% 100% 81% 0%
11th 95% 95% 95% 100% 100% 98% 98% 90% 90% 100% 100% 100% 100% 100% 90% 0% 0% 0% 0% 97% 95% 100% 86% 0%
12th 95% 95% 90% 100% 100% 98% 95% 90% 90% 100% 100% 100% 100% 100% 80% 0% 0% 0% 0% 97% 94% 100% 76% 0%
13th 95% 95% 90% 100% 100% 98% 98% 90% 90% 100% 100% 100% 100% 60% 80% 0% 0% 0% 0% 97% 95% 99% 76% 0%
14th 95% 95% 90% 100% 100% 95% 95% 90% 90% 100% 100% 100% 98% 0% 80% 0% 0% 0% 0% 97% 93% 97% 76% 0%
15th 98% 98% 98% 100% 100% 95% 95% 90% 0% 100% 100% 100% 98% 0% 80% 0% 0% 0% 0% 99% 86% 97% 76% 0%
16th 98% 98% 98% 100% 100% 95% 95% 90% 0% 100% 100% 100% 98% 0% 60% 0% 0% 0% 0% 99% 86% 97% 57% 0%
17th 98% 98% 98% 95% 98% 95% 95% 90% 0% 100% 100% 100% 98% 0% 80% 0% 0% 0% 0% 98% 86% 97% 76% 0%
18th 98% 98% 98% 95% 95% 95% 95% 90% 0% 100% 100% 100% 98% 0% 80% 0% 0% 0% 0% 97% 86% 97% 76% 0%
19th 98% 98% 98% 95% 95% 95% 95% 0% 0% 100% 100% 100% 98% 0% 80% 0% 0% 0% 0% 97% 57% 97% 76% 0%
20th 98% 98% 98% 98% 98% 95% 95% 0% 0% 100% 100% 100% 98% 60% 0% 0% 0% 0% 0% 98% 57% 98% 0% 0%
21st 98% 98% 98% 98% 98% 95% 95% 0% 0% 100% 100% 100% 98% 0% 0% 0% 0% 0% 0% 98% 57% 97% 0% 0%
22nd 98% 98% 98% 90% 90% 95% 95% 0% 0% 100% 98% 98% 98% 0% 0% 0% 0% 0% 0% 95% 57% 96% 0% 0%
23rd 98% 98% 98% 90% 90% 95% 95% 0% 0% 95% 95% 95% 95% 0% 0% 0% 0% 0% 0% 95% 57% 93% 0% 0%
24th 98% 98% 98% 90% 90% 95% 95% 0% 0% 40% 30% 30% 30% 0% 0% 0% 0% 0% 0% 95% 57% 30% 0% 0%
25th 98% 98% 98% 90% 90% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 57% 0% 0% 0%
26th 98% 98% 98% 90% 90% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 57% 0% 0% 0%
27th 98% 98% 98% 90% 90% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 57% 0% 0% 0%
28th 98% 98% 98% 90% 90% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 57% 0% 0% 0%
29th 90% 90% 0% 0% 0% 90% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 43% 0% 0% 0%
File: 01. MEP Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 2:35 PM
Floor
Drainage
Pipes
Support
Fixing
Inst. of
Drainage
Pipes &
Fittings
Drainage
Pipes
Test
Water
Pipes
Support
Fixing
Inst. of
Water
Pipes &
Fittings
Inst. Of
Drainage
Pipes
Riser
Drainage
Riser
Test
Inst. Of
Water
Pipes
Riser
WS Riser
Test
Cutting &
Chasing in
Block
Walls
Fixing
Drainage
Pipes in
Block Walls
Drainage
Pipes
Test
Fixing
Water
Pipes in
Block
Water
Pipes
Test
Inst. &
Connection
to Water
Heater
Inst. of
Identification
Labels
Inst. of
Sanitary
ware
Inst. of
Water
Meter
Inst. of
Floor
Drain
Covers
Plumbing Work Progress
HL Works Prior to Blocks
Final Fix
HL Works
Prior to
Blocks
(60%)
Works Prior
to FC
Clearence
(5%)
Final Fix
(15%)
Shaft Works
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Concealed
MEP
Services
(10%)
Drainage Water Supply
Concealed MEP Services
Works Prior to
False Ceiling
Clearence Shaft
Works
(10%)
Drainage Water Supply
Horizontal
Horizontal Walls
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 50% 40% 0% 0% 0% 90% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22% 43% 0% 0% 0%
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. MEP Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 2:35 PM
Floor
Drainage
Pipes
Support
Fixing
Inst. of
Drainage
Pipes &
Fittings
Drainage
Pipes
Test
Water
Pipes
Support
Fixing
Inst. of
Water
Pipes &
Fittings
Inst. Of
Drainage
Pipes
Riser
Drainage
Riser
Test
Inst. Of
Water
Pipes
Riser
WS Riser
Test
Cutting &
Chasing in
Block
Walls
Fixing
Drainage
Pipes in
Block Walls
Drainage
Pipes
Test
Fixing
Water
Pipes in
Block
Water
Pipes
Test
Inst. &
Connection
to Water
Heater
Inst. of
Identification
Labels
Inst. of
Sanitary
ware
Inst. of
Water
Meter
Inst. of
Floor
Drain
Covers
Plumbing Work Progress
HL Works Prior to Blocks
Final Fix
HL Works
Prior to
Blocks
(60%)
Works Prior
to FC
Clearence
(5%)
Final Fix
(15%)
Shaft Works
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Concealed
MEP
Services
(10%)
Drainage Water Supply
Concealed MEP Services
Works Prior to
False Ceiling
Clearence Shaft
Works
(10%)
Drainage Water Supply
Horizontal
Horizontal Walls
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. MEP Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 2:35 PM
Electrical Work Progress
DAMAC Gulf Properties L.L.C
HL Works Prior to Blocks (Inside and Below Concrete Slab) Shaft Works
Bus
B,Light
,Pow.
Fire
Alarm
Voice
and
Data
Emerg.
Light
Low
Current
HV
Marking & Back Box
Inst. of Conduits for
Lighting & Power
Inst. of Cable Tray /
Pulling Wirirng/Cables
Marking & Back Box
Inst. of Conduits for
Fire Alarm
Inst. of Cable Tray /
Pulling Wirirng/Cables
Marking & Back Box
Inst. of Conduits for
Voice/Data
Inst. of Cable Tray /
Pulling Wirirng/Cables
Marking & Back Box
Inst. of Conduits for
Emerg. Light
Inst. of Cable Tray /
Pulling Wirirng/Cables
Marking & Back Box
Inst. of Conduits for
Low Current
Inst. of Cable Tray /
Pulling Wirirng/Cables
Inst. Of Bus Bar Risers
Inst. Of Cable Risers
Inst. Of Cable Risers
Inst. Of Cable Risers
Inst. Of Cable Risers
Inst. Of HV Cable
Light and Power Fire Alarm Voice and Data Emergency Light
Low Current
(CCTV,Intercom,BMS,Access Control)
DAMAC Heights at Dubai Marina
Floor
Fixing
Trunking
Fixing
Trunking
Fixing
Trunking
Fixing
Trunking
Fixing
Trunking
Risers
B5 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0%
B4 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0%
B3 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0%
B2 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0%
B1 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0%
G 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0%
P1 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0%
P2 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0%
P3 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0%
P4 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0%
P5 95% 95% 0% 0% 95% 95% 0% 0% 95% 95% 0% 0% 95% 95% 0% 0% 95% 95% 40% 40% 0% 0% 0% 0% 0% 0%
6th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 80% 10% 0% 80% 80% 0% 20%
7th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 80% 10% 0% 80% 80% 0% 20%
8th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 80% 10% 0% 80% 80% 0% 20%
9th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 80% 10% 0% 80% 80% 0% 20%
10th 100% 100% 95% 95% 100% 100% 95% 95% 80% 80% 90% 90% 100% 100% 95% 95% 100% 100% 95% 80% 10% 0% 80% 80% 0% 20%
11th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 80% 80% 0% 20%
12th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20%
13th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20%
14th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 90% 95% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20%
15th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 90% 95% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20%
16th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 90% 95% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20%
17th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 90% 70% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20%
18th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 90% 70% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20%
19th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 90% 70% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20%
20th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 90% 70% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0%
21st 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 70% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0%
22nd 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 70% 100% 100% 95% 95% 100% 100% 95% 80% 0% 0% 0% 0% 0% 0%
23rd 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 0% 100% 100% 90% 90% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0%
24th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 0% 0% 100% 100% 90% 90% 100% 100% 40% 0% 0% 0% 0% 0% 0% 0%
25th 80% 80% 65% 65% 100% 100% 80% 80% 100% 100% 0% 0% 100% 100% 90% 90% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0%
26th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 0% 0% 100% 100% 90% 90% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. MEP Progress as of 30-Sep-14 Page 1 of 6 Printed On: 9/30/2014 at 2:35 PM
Electrical Work Progress
DAMAC Gulf Properties L.L.C
HL Works Prior to Blocks (Inside and Below Concrete Slab) Shaft Works
Bus
B,Light
,Pow.
Fire
Alarm
Voice
and
Data
Emerg.
Light
Low
Current
HV
Marking & Back Box
Inst. of Conduits for
Lighting & Power
Inst. of Cable Tray /
Pulling Wirirng/Cables
Marking & Back Box
Inst. of Conduits for
Fire Alarm
Inst. of Cable Tray /
Pulling Wirirng/Cables
Marking & Back Box
Inst. of Conduits for
Voice/Data
Inst. of Cable Tray /
Pulling Wirirng/Cables
Marking & Back Box
Inst. of Conduits for
Emerg. Light
Inst. of Cable Tray /
Pulling Wirirng/Cables
Marking & Back Box
Inst. of Conduits for
Low Current
Inst. of Cable Tray /
Pulling Wirirng/Cables
Inst. Of Bus Bar Risers
Inst. Of Cable Risers
Inst. Of Cable Risers
Inst. Of Cable Risers
Inst. Of Cable Risers
Inst. Of HV Cable
Light and Power Fire Alarm Voice and Data Emergency Light
Low Current
(CCTV,Intercom,BMS,Access Control)
DAMAC Heights at Dubai Marina
Floor
Fixing
Trunking
Fixing
Trunking
Fixing
Trunking
Fixing
Trunking
Fixing
Trunking
Risers
27th 100% 100% 80% 80% 100% 100% 95% 95% 100% 100% 0% 0% 100% 100% 90% 90% 100% 100% 40% 0% 0% 0% 0% 0% 0% 0%
28th 100% 100% 80% 80% 100% 100% 95% 95% 100% 100% 0% 0% 100% 100% 90% 90% 100% 100% 40% 0% 0% 0% 0% 0% 0% 0%
29th 80% 80% 80% 80% 100% 100% 80% 80% 100% 100% 95% 50% 100% 100% 80% 80% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0%
30th 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 0% 0% 100% 100% 0% 0% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0%
31st 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 0% 0% 100% 100% 0% 0% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0%
32nd 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 0% 0% 100% 100% 0% 0% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0%
34th 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0%
35th 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0%
36th 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. MEP Progress as of 30-Sep-14 Page 2 of 6 Printed On: 9/30/2014 at 2:35 PM
Electrical Work Progress
DAMAC Gulf Properties L.L.C
HL Works Prior to Blocks (Inside and Below Concrete Slab) Shaft Works
Bus
B,Light
,Pow.
Fire
Alarm
Voice
and
Data
Emerg.
Light
Low
Current
HV
Marking & Back Box
Inst. of Conduits for
Lighting & Power
Inst. of Cable Tray /
Pulling Wirirng/Cables
Marking & Back Box
Inst. of Conduits for
Fire Alarm
Inst. of Cable Tray /
Pulling Wirirng/Cables
Marking & Back Box
Inst. of Conduits for
Voice/Data
Inst. of Cable Tray /
Pulling Wirirng/Cables
Marking & Back Box
Inst. of Conduits for
Emerg. Light
Inst. of Cable Tray /
Pulling Wirirng/Cables
Marking & Back Box
Inst. of Conduits for
Low Current
Inst. of Cable Tray /
Pulling Wirirng/Cables
Inst. Of Bus Bar Risers
Inst. Of Cable Risers
Inst. Of Cable Risers
Inst. Of Cable Risers
Inst. Of Cable Risers
Inst. Of HV Cable
Light and Power Fire Alarm Voice and Data Emergency Light
Low Current
(CCTV,Intercom,BMS,Access Control)
DAMAC Heights at Dubai Marina
Floor
Fixing
Trunking
Fixing
Trunking
Fixing
Trunking
Fixing
Trunking
Fixing
Trunking
Risers
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. MEP Progress as of 30-Sep-14 Page 3 of 6 Printed On: 9/30/2014 at 2:35 PM
Emerg.
Light
GI Box and Conduits
Light- Pulling
Wirirng/Cables
Power - Pulling
Wirirng/Cables
Fire - Pulling
Wirirng/Cables
Voice/Data - Pulling
Wirirng/Cables
Low Curent - Pulling
Wirirng/Cables
Fire Alarm Devices
above Ceiling
Power Points
Low Current Devices
above Ceiling
Test of Cables and
Test of Cables and
installation,Dressing
and Termination
Inst.of SMDBs
Cables Termination
Inst.of Tap off unit
Inst. of Lights Fixtures
Inst. of Powe & Data
Installation of
Installation of Manual
Pull Station
Voice Evacuation
Installation of
Emergency & Exit
Inst. of CCTV
Inst. of Intercom
Inst. of BMS Devices
Light and Power Fire Alarm
Concealed
MEP
Services
(10%)
Works
Prior to FC
Clearence
(10%)
Works
with FC
Grids
Final Fix
(25%)
Low Current
(CCTV,Intercom,
BMS)
Final Fix
Works
with FC
Grids
Shaft
Works
(5%)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
HL Works
Prior to
Blocks
(50%)
Electrical Work Progress
Concealed MEP Services (Inside
Blocks)
Works Prior to False
Ceiling Clearence
Floor
B5
B4
B3
B2
B1
G
P1
P2
P3
Wires
Wires
DB
Sockets
Detectors
Lights
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0%
P4
P5
6th
7th
8th
9th
10th
11th
12th
13th
14th
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54% 0% 0% 0% 0% 0%
100% 100% 100% 100% 95% 50% 95% 95% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 97% 23% 99% 95% 0% 0%
100% 100% 100% 100% 95% 50% 95% 95% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 97% 23% 99% 95% 0% 0%
100% 100% 100% 100% 95% 100% 95% 95% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 97% 23% 100% 95% 0% 0%
100% 100% 100% 100% 95% 100% 95% 95% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 97% 23% 100% 95% 0% 0%
100% 100% 100% 100% 95% 100% 95% 95% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 23% 100% 95% 0% 0%
100% 100% 100% 100% 95% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 18% 100% 0% 0% 0%
100% 100% 100% 100% 95% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 2% 100% 0% 0% 0%
100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 2% 99% 0% 0% 0%
100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 2% 99% 0% 0% 0%
15th
16th
17th
18th
19th
20th
21st
22nd
23rd
24th
25th
26th
100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 2% 99% 0% 0% 0%
100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 2% 99% 0% 0% 0%
100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 2% 99% 0% 0% 0%
100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 2% 99% 0% 0% 0%
100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 2% 99% 0% 0% 0%
100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 99% 0% 0% 0%
100% 80% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 96% 0% 0% 0%
100% 80% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 97% 0% 96% 0% 0% 0%
90% 90% 90% 90% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 94% 0% 87% 0% 0% 0%
90% 90% 90% 90% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 94% 0% 87% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 94% 0% 0% 0% 0% 0%
File: 01. MEP Progress as of 30-Sep-14 Page 4 of 6 Printed On: 9/30/2014 at 2:35 PM
Emerg.
Light
GI Box and Conduits
Light- Pulling
Wirirng/Cables
Power - Pulling
Wirirng/Cables
Fire - Pulling
Wirirng/Cables
Voice/Data - Pulling
Wirirng/Cables
Low Curent - Pulling
Wirirng/Cables
Fire Alarm Devices
above Ceiling
Power Points
Low Current Devices
above Ceiling
Test of Cables and
Test of Cables and
installation,Dressing
and Termination
Inst.of SMDBs
Cables Termination
Inst.of Tap off unit
Inst. of Lights Fixtures
Inst. of Powe & Data
Installation of
Installation of Manual
Pull Station
Voice Evacuation
Installation of
Emergency & Exit
Inst. of CCTV
Inst. of Intercom
Inst. of BMS Devices
Light and Power Fire Alarm
Concealed
MEP
Services
(10%)
Works
Prior to FC
Clearence
(10%)
Works
with FC
Grids
Final Fix
(25%)
Low Current
(CCTV,Intercom,
BMS)
Final Fix
Works
with FC
Grids
Shaft
Works
(5%)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
HL Works
Prior to
Blocks
(50%)
Electrical Work Progress
Concealed MEP Services (Inside
Blocks)
Works Prior to False
Ceiling Clearence
Floor
27th
28th
29th
30th
31st
32nd
33rd
34th
Wires
Wires
DB
Sockets
Detectors
Lights
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 90% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 90% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45% 0% 0% 0% 0% 0%
35th
36th
37th
38th
39th
40th
41st
42nd
43rd
44th
45th
46th
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th
48th
49th
50th
51st
52nd
53rd
54th
55th
56th
57th
58th
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. MEP Progress as of 30-Sep-14 Page 5 of 6 Printed On: 9/30/2014 at 2:35 PM
Emerg.
Light
GI Box and Conduits
Light- Pulling
Wirirng/Cables
Power - Pulling
Wirirng/Cables
Fire - Pulling
Wirirng/Cables
Voice/Data - Pulling
Wirirng/Cables
Low Curent - Pulling
Wirirng/Cables
Fire Alarm Devices
above Ceiling
Power Points
Low Current Devices
above Ceiling
Test of Cables and
Test of Cables and
installation,Dressing
and Termination
Inst.of SMDBs
Cables Termination
Inst.of Tap off unit
Inst. of Lights Fixtures
Inst. of Powe & Data
Installation of
Installation of Manual
Pull Station
Voice Evacuation
Installation of
Emergency & Exit
Inst. of CCTV
Inst. of Intercom
Inst. of BMS Devices
Light and Power Fire Alarm
Concealed
MEP
Services
(10%)
Works
Prior to FC
Clearence
(10%)
Works
with FC
Grids
Final Fix
(25%)
Low Current
(CCTV,Intercom,
BMS)
Final Fix
Works
with FC
Grids
Shaft
Works
(5%)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
HL Works
Prior to
Blocks
(50%)
Electrical Work Progress
Concealed MEP Services (Inside
Blocks)
Works Prior to False
Ceiling Clearence
Floor
59th
60th
61st
62nd
63rd
64th
65th
66th
Wires
Wires
DB
Sockets
Detectors
Lights
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th
68th
69th
70th
71st
72nd
73rd
74th
75th
76th
77th
78th
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th
80th
81st
82nd
83rd
84th
85th
86th
Roof
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. MEP Progress as of 30-Sep-14 Page 6 of 6 Printed On: 9/30/2014 at 2:35 PM
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 5
Finishes Progress
Architectural Work Progress
Floor Block
Work
Marking,C
utting &
Chasing
Doors
Sub
frame
Fixing
Plaster Floor
Screed
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Dry Area (Bed Room and Living Room) Wet Area (Kitchen, Bathroom and Balacony)
Painting -
Primer
Painting -
Stucco
False Ceiling
Suspension
False
Ceiling
Tiling /
Boardin
Painting -
1st Coat
Floor
Tiles
Timber Doors
&
Ironmongery
Wardrobe
Final
Paint
Coat
Block
Work
Marking,
Cutting &
Chasing
Doors
Sub
frame
Fixing
Plaster Water
proofing
Floor
Screed
Painting -
Primer
Painting -
Stucco Wall Tiles
False
Ceiling
Suspensi
on
False
Ceiling
Tiling /
Boarding
Painting -
1st Coat
Floor
Tiles
Cabinet
Carcass
Vanity
Counters
& Tops
Kitchen
Cabinet
Timber Doors
&
Ironmongery
Shower
Enclosure
Final
Paint
Coat
B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 95% 0% 100% 95% 0% 80% 60% 15% 0% 0% 0% 0% 0% 0% 95% 0% 100% 90% 10% 0% 20% 20% 60% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
7th 95% 0% 100% 95% 0% 80% 60% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 10% 0% 0% 0% 20% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
8th 95% 0% 100% 95% 0% 80% 60% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 10% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
9th 95% 0% 100% 95% 0% 80% 60% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 95% 0% 100% 95% 0% 80% 50% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 95% 0% 100% 95% 0% 80% 40% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 95% 0% 100% 95% 0% 60% 40% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 95% 0% 100% 95% 0% 50% 20% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 95% 0% 100% 95% 0% 50% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 50% 0% 20% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50% 0% 40% 5% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 95% 0% 100% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 95% 0% 100% 15% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 10% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 95% 0% 100% 5% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 5% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 95% 0% 50% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 50% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
26th 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 15% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
29th 5% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Finishes Progress as of 30-Sep-14 Page 1 of 4 Printed On: 9/30/2014 at 11:13 AM
Architectural Work Progress
Floor Block
Work
Marking,C
utting &
Chasing
Doors
Sub
frame
Fixing
Plaster Floor
Screed
Painting -
Primer
Painting -
Stucco
False Ceiling
Suspension
False
Ceiling
Tiling /
Boardin
Painting -
1st Coat
Floor
Tiles
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Timber Doors
&
Ironmongery
Wardrobe
Final
Paint
Coat
Block
Work
Marking,
Cutting &
Chasing
Doors
Sub
frame
Fixing
Plaster Water
proofing
Floor
Screed
Painting -
Primer
Painting -
Stucco Wall Tiles
False
Ceiling
Suspensi
on
False
Ceiling
Tiling /
Boarding
Painting -
1st Coat
Floor
Tiles
Cabinet
Carcass
Vanity
Counters
& Tops
Kitchen
Cabinet
Timber Doors
&
Ironmongery
Shower
Enclosure
Final
Paint
Coat
Dry Area (Bed Room and Living Room) Wet Area (Kitchen, Bathroom and Balacony)
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Finishes Progress as of 30-Sep-14 Page 2 of 4 Printed On: 9/30/2014 at 11:13 AM
Floor
B5
B4
B3
B2
Architectural Work Progress
Marking,Cuttin
g & Chasing
Doors Sub
frame Fixing Plaster Floor Screed Painting -
Primer
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Corridors and Service Rooms Stairs
Painting -
Stucco Floor Tiles Floor Epoxy Wall Tiles False Ceiling
Suspension
False Ceiling
Tiling /
Boarding
Painting - 1st
Coat Steel Doors Final Paint
Coat
Marking,Cuttin
g & Chasing Plaster Floor Screed Painting -
Primer
Painting -
Stucco Floor Epoxy Painting - 1st
Coat
Final Paint
Coat
Handrail
Fixing
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1
G
P1
P2
P3
P4
P5
6th
7th
8th
9th
10th
11th
12th
13th
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 100% 95% 0% 80% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 100% 95% 0% 80% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 100% 95% 0% 80% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 100% 95% 0% 60% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 100% 95% 0% 60% 50% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 100% 95% 0% 60% 40% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 100% 95% 0% 50% 20% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 100% 95% 0% 50% 20% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th
15th
16th
17th
18th
19th
20th
21st
22nd
23rd
24th
25th
26th
27th
28th
0% 100% 95% 0% 20% 10% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 40% 5% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 100% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 100% 10% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 100% 5% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 50% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
29th
30th
31st
32nd
33rd
34th
35th
36th
37th
38th
39th
40th
41st
42nd
43rd
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Finishes Progress as of 30-Sep-14 Page 3 of 4 Printed On: 9/30/2014 at 11:13 AM
Floor
44th
45th
46th
47th
Architectural Work Progress
Marking,Cuttin
g & Chasing
Doors Sub
frame Fixing Plaster Floor Screed Painting -
Primer
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Painting -
Stucco Floor Tiles Floor Epoxy Wall Tiles False Ceiling
Suspension
False Ceiling
Tiling /
Boarding
Painting - 1st
Coat Steel Doors Final Paint
Coat
Marking,Cuttin
g & Chasing Plaster Floor Screed Painting -
Primer
Painting -
Stucco Floor Epoxy Painting - 1st
Coat
Final Paint
Coat
Handrail
Fixing
Corridors and Service Rooms Stairs
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th
49th
50th
51st
52nd
53rd
54th
55th
56th
57th
58th
59th
60th
61st
62nd
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd
64th
65th
66th
67th
68th
69th
70th
71st
72nd
73rd
74th
75th
76th
77th
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th
79th
80th
81st
82nd
83rd
84th
85th
86th
Roof
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Finishes Progress as of 30-Sep-14 Page 4 of 4 Printed On: 9/30/2014 at 11:13 AM
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 6
Ext. Facade Progress
Floor Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan with
Insulation
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Stick Curtain Wall
(From Slab to Slab)
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes
See
Side
Cayan
Tower
Side
Stick Curtain Wall Progress
Marriot
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
Insulation
Insulation
Insulation
B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 52% 52% 52% 26% 0% 92% 92% 92% 46% 0% 61% 61% 61% 0% 0% 87% 87% 87% 40% 0% 44% 78% 46% 73%
7th 52% 52% 52% 26% 0% 92% 92% 92% 46% 0% 61% 61% 61% 0% 0% 87% 87% 87% 43% 0% 44% 78% 46% 74%
8th 52% 52% 52% 26% 0% 92% 92% 92% 46% 0% 61% 61% 61% 0% 0% 87% 87% 87% 40% 0% 44% 78% 46% 73%
9th 52% 52% 52% 26% 0% 92% 92% 92% 46% 0% 61% 61% 61% 0% 0% 87% 87% 87% 43% 0% 44% 78% 46% 74%
10th 52% 52% 52% 26% 0% 92% 92% 92% 46% 0% 61% 61% 61% 0% 0% 87% 87% 87% 43% 0% 44% 78% 46% 74%
11th 52% 52% 52% 26% 0% 92% 92% 92% 46% 0% 61% 61% 61% 0% 0% 87% 87% 87% 43% 0% 44% 78% 46% 74%
12th 52% 52% 52% 26% 0% 92% 92% 46% 46% 0% 61% 61% 0% 0% 0% 87% 87% 43% 43% 0% 44% 62% 24% 58%
13th 52% 52% 26% 26% 0% 92% 92% 46% 46% 0% 61% 61% 0% 0% 0% 87% 87% 43% 43% 0% 35% 62% 24% 58%
14th 52% 52% 26% 26% 0% 92% 92% 46% 46% 0% 61% 61% 0% 0% 0% 87% 87% 43% 43% 0% 35% 62% 24% 58%
15th 52% 52% 26% 26% 0% 92% 92% 46% 46% 0% 61% 61% 0% 0% 0% 87% 87% 43% 43% 0% 35% 62% 24% 58%
16th 52% 52% 26% 26% 0% 92% 92% 46% 46% 0% 61% 61% 0% 0% 0% 87% 87% 43% 43% 0% 35% 62% 24% 58%
17th 52% 52% 26% 26% 0% 92% 92% 46% 46% 0% 61% 61% 0% 0% 0% 87% 87% 43% 43% 0% 35% 62% 24% 58%
18th 52% 52% 26% 0% 0% 92% 92% 0% 0% 0% 61% 30% 0% 0% 0% 87% 30% 0% 0% 0% 30% 37% 14% 15%
19th 52% 42% 0% 0% 0% 92% 45% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17% 20% 0% 0%
20th 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0%
21st 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0%
22nd 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0%
23rd 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0%
24th 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0%
25th 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0%
26th 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0%
27th 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0%
28th 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 3:25 PM
Floor Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan with
Insulation
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Stick Curtain Wall
(From Slab to Slab)
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes
See
Side
Cayan
Tower
Side
Stick Curtain Wall Progress
Marriot
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
Insulation
Insulation
Insulation
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 3:25 PM
Floor Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan with
Insulation
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Stick Curtain Wall
(From Slab to Slab)
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes
See
Side
Cayan
Tower
Side
Stick Curtain Wall Progress
Marriot
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
Insulation
Insulation
Insulation
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 1% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 3:25 PM
Floor Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Unitized Curtain Wall Progress
Unitized Curtain Wall
(On the Slab Edge)
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
Insulation
Insulation
Insulation
Insulation
B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 4% 4% 4% 4%
7th 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 4% 4% 4% 4%
8th 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 4% 4% 4% 4%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 3:25 PM
Floor Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Unitized Curtain Wall Progress
Unitized Curtain Wall
(On the Slab Edge)
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
Insulation
Insulation
Insulation
Insulation
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 3:25 PM
Floor Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Glass
Panels
Saelant
Finsihes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Unitized Curtain Wall Progress
Unitized Curtain Wall
(On the Slab Edge)
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
Insulation
Insulation
Insulation
Insulation
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 1% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 3:25 PM
Floor Brackets
ACP for
Drainage
Enclosure
Glass
Partition
Saelant
Finsihes Brackets
ACP for
Drainage
Enclosure
Glass
Partition
Saelant
Finsihes Brackets
ACP for
Drainage
Enclosure
Glass
Partition
Saelant
Finsihes Brackets
ACP for
Drainage
Enclosure
Glass
Partition
Saelant
Finsihes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Balcony Partition Progress
Balcony Partition
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 3:25 PM
Floor Brackets
ACP for
Drainage
Enclosure
Glass
Partition
Saelant
Finsihes Brackets
ACP for
Drainage
Enclosure
Glass
Partition
Saelant
Finsihes Brackets
ACP for
Drainage
Enclosure
Glass
Partition
Saelant
Finsihes Brackets
ACP for
Drainage
Enclosure
Glass
Partition
Saelant
Finsihes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Balcony Partition Progress
Balcony Partition
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 3:25 PM
Floor Brackets
ACP for
Drainage
Enclosure
Glass
Partition
Saelant
Finsihes Brackets
ACP for
Drainage
Enclosure
Glass
Partition
Saelant
Finsihes Brackets
ACP for
Drainage
Enclosure
Glass
Partition
Saelant
Finsihes Brackets
ACP for
Drainage
Enclosure
Glass
Partition
Saelant
Finsihes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Balcony Partition Progress
Balcony Partition
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 1% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 3:25 PM
Balcony Balustrade Progress
Floor Brackets Aluminium
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Balcony Balustrade
Handrail Vision Glass Saelant
Finsihes Brackets Aluminium
Handrail Vision Glass Saelant
Finsihes Brackets Aluminium
Handrail Vision Glass Saelant
Finsihes Brackets Aluminium
Handrail Vision Glass Saelant
Finsihes
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 26% 0% 0% 0% 44% 0% 0% 0% 25% 0% 0% 0% 40% 0% 0% 0% 1% 2% 1% 2%
7th 26% 0% 0% 0% 44% 0% 0% 0% 25% 0% 0% 0% 40% 0% 0% 0% 1% 2% 1% 2%
8th 26% 0% 0% 0% 44% 0% 0% 0% 25% 0% 0% 0% 40% 0% 0% 0% 1% 2% 1% 2%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 3:25 PM
Balcony Balustrade Progress
Floor Brackets Aluminium
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Balcony Balustrade
Handrail Vision Glass Saelant
Finsihes Brackets Aluminium
Handrail Vision Glass Saelant
Finsihes Brackets Aluminium
Handrail Vision Glass Saelant
Finsihes Brackets Aluminium
Handrail Vision Glass Saelant
Finsihes
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 3:25 PM
Balcony Balustrade Progress
Floor Brackets Aluminium
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Balcony Balustrade
Handrail Vision Glass Saelant
Finsihes Brackets Aluminium
Handrail Vision Glass Saelant
Finsihes Brackets Aluminium
Handrail Vision Glass Saelant
Finsihes Brackets Aluminium
Handrail Vision Glass Saelant
Finsihes
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 1% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 3:25 PM
Floor Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Aluminum
Cladding
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Aluminum
Cladding
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Aluminum
Cladding
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Aluminum
Cladding
Saelant
Finsihes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Balcony Cladding Progress
Balcony Cladding (ACP)
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
Insulation
Insulation
Insulation
Insulation
B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 3:26 PM
Floor Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Aluminum
Cladding
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Aluminum
Cladding
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Aluminum
Cladding
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Aluminum
Cladding
Saelant
Finsihes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Balcony Cladding Progress
Balcony Cladding (ACP)
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
Insulation
Insulation
Insulation
Insulation
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 3:26 PM
Floor Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Aluminum
Cladding
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Aluminum
Cladding
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Aluminum
Cladding
Saelant
Finsihes Brackets
Aluminium
Frame
/Profile
Aluminum
Backpan
with
Aluminum
Cladding
Saelant
Finsihes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Balcony Cladding Progress
Balcony Cladding (ACP)
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
Insulation
Insulation
Insulation
Insulation
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 1% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 3:26 PM
Floor
Brackets
Aluminium
Frame/Profile
Door
Ironmongery
Saelant
Finsihes
Brackets
Aluminium
Frame/Profile
Door
Ironmongery
Saelant
Finsihes
Brackets
Aluminium
Frame/Profile
Door
Ironmongery
Saelant
Finsihes
Brackets
Aluminium
Frame/Profile
Door
Ironmongery
Saelant
Finsihes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Doors Progress
Doors
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 3:25 PM
Floor
Brackets
Aluminium
Frame/Profile
Door
Ironmongery
Saelant
Finsihes
Brackets
Aluminium
Frame/Profile
Door
Ironmongery
Saelant
Finsihes
Brackets
Aluminium
Frame/Profile
Door
Ironmongery
Saelant
Finsihes
Brackets
Aluminium
Frame/Profile
Door
Ironmongery
Saelant
Finsihes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Doors Progress
Doors
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 3:25 PM
Floor
Brackets
Aluminium
Frame/Profile
Door
Ironmongery
Saelant
Finsihes
Brackets
Aluminium
Frame/Profile
Door
Ironmongery
Saelant
Finsihes
Brackets
Aluminium
Frame/Profile
Door
Ironmongery
Saelant
Finsihes
Brackets
Aluminium
Frame/Profile
Door
Ironmongery
Saelant
Finsihes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Doors Progress
Doors
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 1% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 3:25 PM
Floor Brackets Aluminium
Frame/Profile Louver Tension
Rod
Saelant
Finsihes Brackets Aluminium
Frame Louver Tension
Rod
Saelant
Finsihes Brackets Aluminium
Frame/Profile Louver Tension
Rod
Saelant
Finsihes Brackets Aluminium
Frame Louver Tension
Rod
Saelant
Finsihes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Louvers Progress
Louvers
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 3:26 PM
Floor Brackets Aluminium
Frame/Profile Louver Tension
Rod
Saelant
Finsihes Brackets Aluminium
Frame Louver Tension
Rod
Saelant
Finsihes Brackets Aluminium
Frame/Profile Louver Tension
Rod
Saelant
Finsihes Brackets Aluminium
Frame Louver Tension
Rod
Saelant
Finsihes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Louvers Progress
Louvers
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 3:26 PM
Floor Brackets Aluminium
Frame/Profile Louver Tension
Rod
Saelant
Finsihes Brackets Aluminium
Frame Louver Tension
Rod
Saelant
Finsihes Brackets Aluminium
Frame/Profile Louver Tension
Rod
Saelant
Finsihes Brackets Aluminium
Frame Louver Tension
Rod
Saelant
Finsihes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Louvers Progress
Louvers
Marriot
Side
Cayan
Tower
Side
See
Side
Marina
Side
Marriot Side Cayan Tower Side See Side Marina Side
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
87th 1% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Facade Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 3:26 PM
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 7
Lifts Progress
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
DAMAC Gulf Properties L.L.C
Counter
Weight
Assembl
DAMAC Heights at Dubai Marina
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Lift Car
Cabin
Wiring Final
Finishes
Lift Machine Room
Lift
Car
Cabin
(5%)
Lifts Work Progress (Lift - L1)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Shaft
(70%)
Lift Shaft Lift Entrance Door
Rails
Rails
Platfor
bly
y
Frames
Fixing
B5 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A 0% 13% 0% N/A 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 5% 0% N/A N/A
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:41 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
DAMAC Gulf Properties L.L.C
Counter
Weight
Assembl
DAMAC Heights at Dubai Marina
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Lift Car
Cabin
Wiring Final
Finishes
Lift Machine Room
Lift
Car
Cabin
(5%)
Lifts Work Progress (Lift - L1)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Shaft
(70%)
Lift Shaft Lift Entrance Door
Rails
Rails
Platfor
bly
y
Frames
Fixing
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
54th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
55th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
56th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
57th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 0% 0% 0% 0% 0% 0% N/A N/A N/A 0% N/A
58th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
59th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
60th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
61st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
62nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
63rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
64th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
65th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
66th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
67th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:41 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
DAMAC Gulf Properties L.L.C
Counter
Weight
Assembl
DAMAC Heights at Dubai Marina
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Lift Car
Cabin
Wiring Final
Finishes
Lift Machine Room
Lift
Car
Cabin
(5%)
Lifts Work Progress (Lift - L1)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Shaft
(70%)
Lift Shaft Lift Entrance Door
Rails
Rails
Platfor
bly
y
Frames
Fixing
68th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
69th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
70th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
71st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
72nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
73rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
74th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
75th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
76th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
77th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
78th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
79th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
80th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
81st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
82nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
83rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
84th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
85th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
86th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
Roof N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 1% N/A 1% N/A 1% N/A
File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:41 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - L2)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
B5 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A 0% 13% 0% N/A 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 5% 0% N/A N/A
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:41 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - L2)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
54th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
55th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
56th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
57th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 0% 0% 0% 0% 0% 0% N/A N/A N/A 0% N/A
58th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
59th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
60th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
61st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
62nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
63rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
64th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
65th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
66th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
67th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:41 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - L2)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
68th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
69th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
70th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
71st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
72nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
73rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
74th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
75th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
76th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
77th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
78th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
79th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
80th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
81st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
82nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
83rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
84th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
85th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
86th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
Roof N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 1% N/A 1% N/A 1% N/A
File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:41 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - L3)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
B5 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A 0% 13% 0% N/A 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 5% 0% N/A N/A
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:41 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - L3)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A
54th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
55th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
56th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
57th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 0% 0% 0% 0% 0% 0% N/A N/A N/A 0% N/A
58th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
59th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
60th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
61st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
62nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
63rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
64th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
65th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
66th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
67th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:41 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - L3)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
68th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
69th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
70th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
71st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
72nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
73rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
74th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
75th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
76th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
77th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
78th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
79th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
80th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
81st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
82nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
83rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
84th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
85th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
86th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A
Roof N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 1% N/A 1% N/A 1% N/A
File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:41 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - L4)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
B5 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - L4)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - L4)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1% 1%
File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - L5)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
B5 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - L5)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - L5)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1% 1%
File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - L6)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
B5 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - L6)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - L6)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1% 1%
File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - M7)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - M7)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - M7)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1% 1% 1%
File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - M8)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - M8)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - M8)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1% 1% 1%
File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - M9)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - M9)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - M9)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1% 1% 1%
File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:42 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - H10)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:43 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - H10)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:43 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - H10)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1%
File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:43 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - H11)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:43 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - H11)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:43 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - H11)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1%
File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:43 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - H12)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
B5 20% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 0%
B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:43 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - H12)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:43 PM
Floor
Prelim.
Works (Incl.
Scaffolding)
Seperator
Steel
Beams
Lift
Cabin
Bracket
Counter
Weight
Bracket
Lift
Cabin
Guide
Counter
Weight
Guide
Lift
Cabin
Frame
&
Counter
Weight
Frame
Lift
Cabin
Assem
Counter
Weight
Assembl
Roping Elec.
Wiring
Shaft
Lighting
Landing
Entrance
Door
Landing
Entrance
Door
Landing
Entrance
Door Panels
Elec.
Wiring Brakes Motor
V3F
Control
System
Auto.
Leveling
Device
Auto.
Rescue
Device
Wiring Final
Finishes
Lift
Machine
Room
(15%)
Lift
Car
Cabin
(5%)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Lifts Work Progress (Lift - H12)
Lift Shaft Lift Entrance Door Lift Machine Room
Lift Car
Cabin
Lift
Shaft
(70%)
Lift
Entr.
Door
(10%)
Rails
Rails
Platfor
bly
y
Frames
Fixing
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1%
File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:43 PM
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 8
Garbage Chute
Progress
Floor
Chute
Support
Frame
Shaft Works Garbage Room in Ground Floor Garbage
Chute Tube
Water
Supply Line
for Cleaning
Water
Supply Line
for Fire
Fighting
Electrical
Cables
Chute Intake
Door
Fire
Sprilnklers
Cleaning
Sprilnklers
Automatic
Brushing
Device
Flushing
Spray Head Wire Mesh Exhaust Fan
Chute
Covering in
Slope
Containers Fire Shutter
Door
Garbage
Compactor
Panel
Installation
Top Roof Vent
Garbage Room in Typical
Floors
Room in
Ground
Floor
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Top Roof
Vente
Shaft
Works
Garbage Chute Progress
Garbage
Room in
Typical
Floors
B5
B4
B3
B2
B1
G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
6th 100% 100% 100% 100% 100% 0% 0% 0% 100% 0%
7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Garbage Chute as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:45 PM
Floor
Chute
Support
Frame
Shaft Works Garbage Room in Ground Floor Garbage
Chute Tube
Water
Supply Line
for Cleaning
Water
Supply Line
for Fire
Fighting
Electrical
Cables
Chute Intake
Door
Fire
Sprilnklers
Cleaning
Sprilnklers
Automatic
Brushing
Device
Flushing
Spray Head Wire Mesh Exhaust Fan
Chute
Covering in
Slope
Containers Fire Shutter
Door
Garbage
Compactor
Panel
Installation
Top Roof Vent
Garbage Room in Typical
Floors
Room in
Ground
Floor
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Top Roof
Vente
Shaft
Works
Garbage Chute Progress
Garbage
Room in
Typical
Floors
32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
File: Garbage Chute as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:45 PM
Floor
Chute
Support
Frame
Shaft Works Garbage Room in Ground Floor Garbage
Chute Tube
Water
Supply Line
for Cleaning
Water
Supply Line
for Fire
Fighting
Electrical
Cables
Chute Intake
Door
Fire
Sprilnklers
Cleaning
Sprilnklers
Automatic
Brushing
Device
Flushing
Spray Head Wire Mesh Exhaust Fan
Chute
Covering in
Slope
Containers Fire Shutter
Door
Garbage
Compactor
Panel
Installation
Top Roof Vent
Garbage Room in Typical
Floors
Room in
Ground
Floor
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Top Roof
Vente
Shaft
Works
Garbage Chute Progress
Garbage
Room in
Typical
Floors
69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0%
Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 0% 0% 1%
File: Garbage Chute as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:45 PM
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 9
Long Lead Items Log
Long Lead Items Status
Planned Actual Planned Actual Planned
Expected/
Actual
Planned
Days
Actual
Days
Origin Method Arrival Custom Planned
Expected/
Actual
Mechanical
HVAC Works
1 FAHU 08.Mai.14 03.Mär.14 25.Mai.14 10.Jun.14 03.Jun.14 22.Jun.14 160 14.Dez.14 15.Dez.14 Behind -1
2 Fans (Pressurization, Parking Extract,etc) Nuaire 14.Jun.14 12.Mär.14 30.Jun.14 01.Jul.14 08.Jul.14 22.Jul.14 160 19.Jän.15 15.Nov.14 Ahead 65
3 Chilled Water Pumps ALLIED 14.Jun.14 05.Mär.14 30.Jun.14 19.Jul.14 08.Jul.14 24.Aug.14 160 19.Jän.15 30.Nov.14 Ahead 50
4 Cooling Tower 18.Dez.14 25.Mai.14 05.Jän.15 07.Aug.14 13.Jän.15 15.Okt.14 160 22.Jul.15 13.Feb.15 Ahead 159
5 Chiller 08.Jun.14 08.Mär.14 24.Jun.14 23.Jul.14 02.Jul.14 21.Jun.14 180 05.Feb.15 15.Mär.15 Behind -38
6 Heat Exchanger (HEX) Faisal jassim 15.Mai.14 02.Feb.14 02.Jun.14 03.Jul.14 10.Jun.14 22.Jul.14 160 21.Dez.14 30.Okt.14 Ahead 52
7 Air Outlet
Plumbing
1 Sump Pump 29.Sep.14 29-Jun-14 18.Okt.14 14-Aug-14 27.Okt.14 15.Okt.14 120 18.Mär.15 15.Dez.14 Ahead 93
2 Booster Pump 29.Sep.14 3-Jun-14 18.Okt.14 8-Jul-14 27.Okt.14 15.Okt.14 120 18.Mär.15
3 Transfer Pump 29.Sep.14 3-Jun-14 18.Okt.14 8-Jul-14 27.Okt.14 15.Okt.14 120 18.Mär.15
4 Sewage Pump 29.Sep.14 29-Jun-14 18.Okt.14 14-Aug-14 27.Okt.14 15.Okt.14 120 18.Mär.15 15.Dez.14 Ahead 93
5 GRP Water Tank 4-Jun-14 14-Aug-14 15.Okt.14
Fire Fighting
1 Fire Pump 08.Jun.14 18-May-14 24.Jun.14 5-Jun-14 02.Jul.14 15.Okt.14 180 05.Feb.15 15.Mär.15 Behind -38
2 FM 200 System 07.Okt.14 23.Okt.14 02.Nov.14 180 03.Jun.15
3 Foam Spray System for Generator 14-May-14 8-Jul-14
4 Fire Alarm Devices 11.Mär.14 16-Feb-14 27.Mär.14 4-Jun-14 05.Apr.14 23.Jun.14 150 30.Sep.14 30.Sep.14 Ahead 0
Electrical
Electrical
1 Bus Bars 26.Jul.14 05.Mär.14 13.Aug.14 22.Jun.14 21.Aug.14 15.Okt.14 120 14.Jän.15 15.Feb.15 Behind -32
2 Wiring Accessories 12.Nov.14 16.Apr.14 29.Nov.14 02.Jun.14 08.Dez.14 15.Okt.14 100 05.Apr.15 15.Dez.14 Ahead 111
3 LV Panels and Switchgear 25.Jun.14 18.Mär.14 12.Jul.14 21.Jul.14 20.Jul.14 15.Okt.14 120 14.Dez.14 15.Feb.15 Behind -63
4 Generators 02.Aug.14 24.Aug.14 18.Aug.14 16.Sep.14 26.Aug.14 15.Okt.14 180 30.Mär.15 15.Feb.15 Ahead 43
5 LV Cables
6 MV Cables 26.Mai.14
7 UPS
Low Current System
1 BMS 12.Nov.14 25.Mai.14 29.Nov.14 08.Sep.14 08.Dez.14 15.Okt.14 120 28.Apr.15 15.Jän.15 Ahead 103
2 FA System Panels 03.Apr.14 16-Feb-14 20.Apr.14 4-Jun-14 28.Apr.14 23.Jun.14 150 27.Okt.14 30.Sep.14 Ahead 27
3 Access Control System 07.Apr.14 21.Aug.14
4 Audio Itercom System 09.Apr.14 25.Sep.14
5 CCTV System 07.Apr.14 21.Aug.14
6 Central Battery System 18.Feb.14 15.Jul.14
7 GSM System
Notes:
The Forecast Delivery Dates were given by ATC/REMCO.
Material Submittal Submittal Approval SHIPMENT
Required On Site
(Delivery Date)
Delay
Ahead/
Behind
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Purchase Order
Fabrication and Delivery
SPECS Supplier/
Period
MATERIAL DESCRIPTION
Section
Subcont.
File :- Page 1 of 1 Printed On :- 13.10.2014 at 13:19
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 10
Provisional Sum
Nomination Log
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Items Notes
Branded Apartments
Sanitary Wares:
Bathtub, Wash Basin, WC and Bidets 20.Apr.14 Alamana Building Materials Re-nomination will be done
Light Fittings
Kitchen Sink and Sink Mixers 30.Apr.14 Teka Kuchentechnik
Fit Out
Toilet Access:
Bidet mixer, Basin Mixer, Shower set,
Bath mixer, Hand spray, Toilet paper
holder, Towel ring, Towel rail, Soap
dish, Robe hook, Bath grip.
01.Jun.14 Paradosso Trading L.L.C
Shower Enclosures
Non Branded Apartments
Sanitary Wares:
Bathtub, Wash Basin, WC and Bidets 20.Apr.14 Danube Building Materials Re-nomination will be done
Light Fittings 20.Apr.14
Istanbul Electrical Ware
Trading
Fit Out :
Timber Doors
Ironmongery
Wardrobes
Kitchen Cabinets
Vanities
Mirrors
GRC Cornice
Shower Enclosures
Toilet Access.
03.Apr.14
JC Maclean International
Toilet Access:
Bidet mixer, Basin Mixer, Bath mixer,
Shower set, Hand spray and Toilet
paper holder.
01.Jun.14 Shamsi Gen. Trading
Kitchen Sink and Sink Mixers 28.Mai.14
Kitchen Sink: United Supplies
Materials
Sink Mixers: Danube Building
Materials
Planned (as per TCP-Rev 02) Actual
Nominations of PS Items
LOI Issuance by
DAMAC
Contract Signed
by ATC
LON Issued by
DAMAC
Contract Signed
by Both Parties
Nomination
Status
Contract
Signature
Status
Engieer
Instruction
ATC Acceptance
Sub-Contractors / Suppliers
File:- Page1 of 2 Printed On: 08.10.2014 at 13:21
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Items Notes
Planned (as per TCP-Rev 02) Actual
Nominations of PS Items
LOI Issuance by
DAMAC
Contract Signed
by ATC
LON Issued by
DAMAC
Contract Signed
by Both Parties
Nomination
Status
Contract
Signature
Status
Engieer
Instruction
ATC Acceptance
Sub-Contractors / Suppliers
Ground Floor
Sanitary Wares:
Bathtub, Wash Basin, WC and Bidets 20.Apr.14 Alamana Building Materials Re-nomination will be done
Fendi Fit Out (Entrance Lobby
,Corridor, Reception Area, Lift Lobby,
Lift Car):
Ceiling, Flooring and Walls
Light Fittings
FF&E
Life Style (Podium 5)
Sanitary Wares 20.Apr.14 Alamana Building Materials Re-nomination will be done
Fit Out:
Ceiling, Flooring and Walls
Light Fittings
FF&E
Lockers
Steam and Sauna
Jacuzzi
Acrylic Panel enclosures for Jacuzzi
Pool Furniture
Hard and Soft Landscaping Package 09.Jun.14 Jobian Concept
Swimming Pool Package
Public Areas
Electromechanical Package 17.Jul.13 REMCO
Lifts Package 16.Jän.13 Toshiba
BMU Package 17.Nov.13 Danway
Façade Aluminum Package 08.Okt.13 ALICO
Façade Lighting Package
Steel Structure Package 04.Dez.14 15.Dez.14 08.Apr.14
Noterdam Metal
Construction
Light Fittings for BOH 12.Okt.14 25.Okt.14 24.Mär.14
Istanbul Electrical Ware
Trading
Light Fittings for Corridors 20.Apr.14
Istanbul Electrical Ware
Trading
Steel doors for service rooms for Non
Branded Apartments floors
25.Aug.14 Qatar Metal Const. Ind LLC
Internal and External Signage
File:- Page2 of 2 Printed On: 08.10.2014 at 13:21
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 11
Building Permit Status
Building Permit Status
Risk Score
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Description Owner Status
Ramboll
1 Closed
AECOM
2 Closed
3 Low
4 Low
5 Low
Thermal insulation approval from DM and ventilation for Chillers:
Obtained.
6 Closed
7 Closed
Risk Score Breakdown
AECOM Closed
FIC final approval:
Obtained.
AECOM Closed
Letter of appointment for Notre Dame Steel:
It will be submitted when the shop drawings are ready. Condition to
cleared prior to commencement of the related work.
ATC / Notredam Open
Acceptance of the External paving:
To be approved prior to Building Completion Certificate application.
ATC Open
Structural Steel Shop Drawing Approval:
Condition to be cleared prior to commencement of the related work
above lev el 84.
Closed
ATC / Notredam Open
DCD approval on level P5:
(Awaiting RME package). Condition to be cleared prior to casting
level 45.
Closed
DCA NOC for Building height:
Obtained
5
4
3
2
1
0
Medium Low Closed
Medium
Low
Closed
File :- Page 1 of 1 Printed On :- 08.10.2014 at 13:19
المباني ߰ إدارة
البناء ߰ تراخيص ߰ قسم
تعديلت ߰ أعمال ߰ تصريح
الصدار ߰ 187558
تاريخ - 34 - التصريح :
1 ߰ رقم
المالك : ߰ اسم
:
المنطقة : ߰ :
اسم
߰ الرض ߰ رقم
الرخصة : ߰ نوع
العمل : ߰ وصف
17/09/2014
داماك الخليج للعقارات - ش.ذ.م.م
3920569 مرسى دبي
ترخيص أعمال تعديلت وإضافات بسيطة )استشاري، مقاول(
1-25- إلغاء شرط الدفاع المدني للطابق الخامس من المعاملة رقم 187558
17/09/ الطباعة : 2014 ߰ تاريخ
:2 ߰
رقم
المبنى
الستشاري
)ايكوم ميدل ايست ليمتد )فرع دبى
رقم
044391001 الرخصة :
الهاتف :
الفاكس :
044391000
120196
߰
:
الستشاري
߰ القديم :
المجموعة الستشارية العالمية المنفذة : ߰ الشركة
الرخصة الهاتف :
3404004 3400700
߰
الفاكس :
رقم
)ارابتك للنشاءات )ش.ذ.م.م
216599
:
17/09/2014
الثانوي : ߰ المقاول
الرخصة :
الهاتف : الفاكس : ߰
رقم
:
التاريخ
201400457848
:
اليصال ߰ رقم
قيمة
قيمة
2014/12/31 00:تأمين المقاول 00:00 :
G022940
:
߰ رقم
߰ ߰
اليصال التاريخ
ضمان بنكي
الرسوم :
325 ߰
:
التجديدات : التجديد الرقــــم : التاريخ :
تسمية المقاول لعمال المنشآت الحديدية القياسية )قبل بدء العمل(
إعتماد مخططات المنشأ الحديدي )قبل بدء العمل(
المراجعة بخصوص الرصف الخارجي قبل النجاز )قبل اصدار شهادة النجاز(
خاصة : ߰
اشتراطات
عامة : ߰
اشتراطات
العمل. ߰ بموقع ߰ والسلمة ߰ المن ߰ بقواعد ߰ التام ߰ اللتزام ߰ مع ߰ الترخيص ߰ هذا ߰ مع ߰ المعتمدة ߰ للمخططات ߰߰ طبقا ߰ بالعمل ߰ المذكور ߰ للمقاول ߰ يسمح ߰.1
أشهر. ߰ ستة ߰ عن ߰ تزيد ߰ لمدة ߰ الموقع ߰ في ߰߰ كليا ߰ العمل ߰ توقف ߰ إذا ߰ أو ߰ الصدار ߰ تاريخ ߰ من ߰ أشهر ߰ ستة ߰ خلل ߰ العمل ߰ يبدأ ߰ لم ߰ إذا ߰ الترخيص ߰ 2. يلغى
.߰ العمل ߰ من ߰ النتهاء ߰ عند ߰ التأمبن ߰ واسترداد ߰ النجاز ߰ شهادة ߰ واصدار ߰ المفتوحة ߰ المعاملت ߰ اغلق ߰ المقاول ߰ على ߰.3
.߰ الجوار ߰ أو ߰ الممتلكات ߰ أو ߰ الفراد ߰ في ߰ أضرار ߰ أو ߰ إصابات ߰ أي ߰ حدوث ߰ حال ߰ في ߰߰ الطوارئ ߰ قسم ߰ إبلغ ߰ يجب ߰.4
المباني ߰ إدارة ߰ مدير
.߰߰ بالبناء ߰ الخاصة ߰ والشتراطات ߰ والقوانين ߰ المحلية ߰ الوامر ߰ إتباع ߰ يجب ߰.5
والجوار. ߰ الموقع ߰ نظافة ߰ على ߰ والمحافظة ߰ العمل ߰ ومخلفات ߰ النقاض ߰ إزالة ߰ المقاول ߰ على ߰.6
دبي. ߰ امارة ߰ في ߰ المفعول ߰ سارية ߰ رخص ߰ لديهم ߰ الفرعيين ߰ المقاولين ߰ كافة ߰ أن ߰ من ߰ التأكد ߰ الرئيسي ߰ والمقاول ߰ الستشاري ߰ على ߰7.
.)8004999(߰)2232323(:߰ البلدية ߰ طوارئ ߰ هاتف
العالم ߰ حلم ߰ مبانينا ߰:߰ رؤيتنا
صفحة 1 من 2
اللكتروني. ߰ للنظام ߰ الرجوع ߰ يرجى ߰ المعتمدة ߰ البناء ߰ وأنظمة ߰ الشروط ߰ كافة ߰ على ߰ للطلع ߰.8
17/09/14
3920569
187558-34-1
المباني ߰ إدارة
البناء ߰ تراخيص ߰ قسم
تعديلت ߰ أعمال ߰ تصريح
الصدار ߰ 187558 تاريخ - 34 - التصريح :
1 ߰
رقم
المالك : ߰ اسم
17/09/2014 :
داماك الخليج للعقارات - ش.ذ.م.م
3920569 مرسى دبي
المنطقة : ߰ :
اسم
17/09/ الطباعة : 2014 ߰ تاريخ
الجديد ߰ الرض ߰ رقم
الخدمات: ߰ شروط
تامدخ ߰ لصتال ߰)߰ ةقفاوم ߰ )تالصتا
معتمدة
:߰ المهندس ߰ قرار
All Etisalat requirements should be provided as per 2013 Etisalat design guideline for fiber to home
considering the following conditions:•12U cabinet to be fixed at a height of 40cm to 120cm from finished
floor level•MIN Tel box size should be 40x60x12 for residential premises which have more than two bed
room •12U size should be 60x60x30 for commercial•42Ucabinet to be provided in Etisalat room with
required ODFs and splitters •The 12u cab or MINI Tel should be equipped with the following:oPatch panels
suiting the required no of RJ45 socketsoPower socket oAir circulationoVertical cable managementoMini
ODFoNote:-The above items should be provided as shown on Etisalat guide lines amendments. •Fiber optic
cable should comply with ITU-T G652B and terminated with SC/APC connectors • 2core fib
المباني ߰ إدارة ߰ مدير
.)8004999(߰)2232323(:߰ البلدية ߰ طوارئ ߰ هاتف
العالم ߰ حلم ߰ مبانينا ߰:߰ رؤيتنا
صفحة 2 من 2
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 12
Technical Review Log
Technical Review Reports
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Transmission Provisional Sum
Report #
(FH/DH/R/..) To Ref. Date
Category Details Discipline Revision Remarks
0001 Design Review MEP Peer Review Reports MEP 0 DAMAC 0010 03-Mär-14
0002 Handover DAMAC Heights Project Handover Report General 0 DAMAC 0023 03-Mär-14
0003 Design Review DAMAC Heights Design Review Report General 0 DAMAC 0026 03-Mär-14
0004 SH&E AECOM HSE Interim Status Report SH&E 0 DAMAC 0033 10-Mär-14
0005 Factory Visit Low Voltage Switchgear Assembly Electrical 0 DAMAC 0291 24-Apr-14
0006 Tender Analysis Report Metal Doors Package Architectural 0 DAMAC 0332 28-Apr-14
0007 Factory Visit Low Voltage Switchgear Assembly Electrical 1 ATC 0354 29-Apr-14
0008 Technical Report Design Conflicts and Proposed Solutions Architectural 0 DAMAC 0480 15-Mai-14
0009 Factory Visit
Assessment of Performance and Quality of Ready mix
Beton
Structural 0 DAMAC 0513 19-Mai-14 RE
0010 Technical Report
Diaphragm Walls Inspection and Recommendation -
Ground Voids & Water Seepage Assessment
Structural 0 DAMAC 0518 19-Mai-14
0011 Tender Analysis Report
Evaluation of Bidders for ID Fit-out and FF&E Works
(Fendi GF and P5)
Architectural 0 DAMAC 0519 27-Mai-14
0012 Technical Report Material Submit for Façade Lighting - TEO 24 Electrical 0 DAMAC 0555 22-Mai-14
0013 Evaluation Report REMCO Performance MEP 0 DAMAC 0674 09-Jun-14
0014 Design Review
MEP Peer Review Reports - Comments Response /
Feedback
MEP 1 DAMAC 0675 10-Jun-14 R# 0001
0015 Tender Analysis Report Metal Doors Package Architectural 1 DAMAC 0701 11-Jun-14 R# 0006
0016 Snag Report Mock-up Flat Unit 7307 (Ocean Heights) General 0 DAMAC 0743 16-Jun-14
0017 Technical Report Design Conflicts and Proposed Solutions (RFIs) Architectural 0 DAMAC 0782 22-Jun-14
0018 Technical Report Assessment of Slipform System Structural 0 DAMAC 0785 22-Jun-14
0019 Technical Report Service Doors Assessments Architectural 0 DAMAC 0844 30-Jun-14 PE
0020 Technical Report Pressure Grouting Structural 0 DAMAC 0864 07-Jul-14
0021 SH&E Safety Review Report - AECOM CSO Site Visit SH&E 0
Andy
Peters
- 21-Jul-14
0022 Tender Analysis Report Metal Doors Package (Responsibility Matrix) Architectural 2 DAMAC 1000 24-Jul-14
0023 Technical Report AECOM Review of Basement Cracks Structural 0 DAMAC 1049 11-Aug-14
0024 Tender Analysis Report
Evaluation of Bidders for Interior Fit-out Works Package
(Fendi Apartments L43-L84)
Architectural 0 DAMAC 1107 10-Aug-14
0025 Technical Report Balcony Drain Pipe Enclosure Proposal Architectural 0 DAMAC 1299 03-Sep-14
0026 Technical Report
Discrepancies in Kitchen Architectural Layout (Level 26 -
Level 42)
Architectural 0 DAMAC 1381 16-Sep-14
Ref.
File: Page 1 of 2 Printed On:08.10.2014 at 13:38
Technical Review Reports
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Transmission Provisional Sum
Report #
(FH/DH/R/..) To Ref. Date
Category Details Discipline Revision Remarks
Ref.
0027 Technical Report
Water Ingress Through Diaphragm Wall Joint - 17
September 2014
Structural 0 DAMAC 1432 23-Sep-14
File: Page 2 of 2 Printed On:08.10.2014 at 13:38
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 13
Outstanding RFIs
Outstanding Request for Information (RFIs)
RFI No. Rev. Discipline Date Raised Description
AECOM
Reciept
Due for
Response
Current
Date
No of Days
Pending
Forwarded to
AECOM
Reponse
218 1 Structural 18-Aug-14 Grade of Concrete to be used inside lift pit. 18-Aug-14 1-Sep-14 30-Sep-14 -29 Reuben
291 1 Structural 31-Mar-14
Design Parameters & Sequence to Dismantle Section D-D Steel Strutting
Members
31-Mar-14 14-Apr-14 30-Sep-14
Reuben /
To Ramboll on
10.04.14 via
Ramboll Returned -
No action from
Ramboll
422 1 Architectural 6-Apr-14 Balcony Drain Pipes. 6-Apr-14 20-Apr-14 30-Sep-14
Bassem / Commetns
to client
27-May-14
454 1 Structural 31-Mar-14 Struts Removal Phases 31-Mar-14 14-Apr-14 30-Sep-14 -169 Reuben Client to advise
534 1 Architectural 16-Apr-14 Insulation Aluminium Panel Cladding 17-Sep-14 1-Oct-14 30-Sep-14 1
537 2 Architectural 25-Aug-14 Thickness for cabin interior finishes for elevators 26-Aug-14 9-Sep-14 30-Sep-14 -21 Ramon / Haddad
579 2 Architectural 23-Aug-14 Revised Elevation and section for GR to P5 24-Aug-14 7-Sep-14 30-Sep-14 -23 Ramon / Haddad
597 0 Architectural 4-Jun-14 LF-22 Storage Cabinet 4-Jun-14 18-Jun-14 30-Sep-14
Ramon /
To Damac on
28-Aug-14
626 1 Architectural 3-Aug-14 Structural steel metal works drawings for mechanical plant room floors 3-Aug-14 17-Aug-14 30-Sep-14 -44 Ramon / Haddad
630 0 Architectural 7-Jul-14 Balcony drain pipes enclosure in elevation building elevations 7-Jul-14 21-Jul-14 30-Sep-14 -71 Ramon / Haddad
636 1 Architectural 3-Aug-14 Slab Edge Drawings not matching with architectural drawings 3-Aug-14 17-Aug-14 30-Sep-14 -44
Reuben / To Ramboll
on 25.08.2014
652 0 Architectural 17-Jul-14 Corewall openings at level 30 17-Jul-14 31-Jul-14 30-Sep-14 Haddad 23-Jul-14
666 0 Architectural 3-Aug-14 Door Type WD55 3-Aug-14 17-Aug-14 30-Sep-14 -44 Ramon / Haddad
667 0 Architectural 3-Aug-14 WD51 - Concrete opening unified size 3-Aug-14 17-Aug-14 30-Sep-14 Haddad 18-Aug-14
681 0
Architectural /
Structural
13-Aug-14 Clashes between BMU and the Corewall at Axis (E) 16-Aug-14 30-Aug-14 30-Sep-14 -31
Reuben / To Ramboll
on 17.08.2014 /
683 0 Structural 14-Aug-14 Level 86 Thickness and SSL 14-Aug-14 28-Aug-14 30-Sep-14 -33
Reuben / To Ramboll
on 25.08.2014
684 1 Architectural 27-Aug-14 Steel Support for Curtain Wall at P5 28-Aug-14 11-Sep-14 30-Sep-14 -19 Ramon / Haddad
685 0 Mechanical 16-Aug-14 Exit Light above stair case door 18-Aug-14 1-Sep-14 30-Sep-14 -29 Ramon / Haddad
694 1 Architectural 28-Sep-14 Discrepancies in Bathrooms Architectural Layout ( 31st to 42nd Floors ) 28-Sep-14 12-Oct-14 30-Sep-14 12 Haddad
710 0
Architectural /
Mechanical / Electrical
4-Sep-14 DB / ONTB Recessed in concrete wall (to 43rd to 85th Floors) 6-Sep-14 20-Sep-14 30-Sep-14 -10
686 0 Architectural 19-Aug-14 Discrepancy in plans & elevations for Kitchen type K-26 Level 26 to 27 20-Aug-14 3-Sep-14 30-Sep-14 Haddad 6-Sep-14
715 0
Architectural /
Structural / Mechanical
6-Sep-14 ID Drawings 8-Sep-14 22-Sep-14 30-Sep-14 -8
Haddad / Raouf /
Reuben
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
File:- Page1 of 2 Printed On:12.10.2014 at 07:12
Outstanding Request for Information (RFIs)
RFI No. Rev. Discipline Date Raised Description
AECOM
Reciept
Due for
Response
Current
Date
No of Days
Pending
Forwarded to
AECOM
Reponse
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
721 0 Architectural 8-Sep-14 Required Counter Depth for Microwave Oven 9-Sep-14 23-Sep-14 30-Sep-14 -7
728 0
Architectural /
Structural / Mechanical
11-Sep-14 Head Room Clearance at Level 86 11-Sep-14 25-Sep-14 30-Sep-14 -5
724 0
Architectural /
Structural / Mechanical
10-Sep-14 FFL and SSL from Levels 80 to 88 13-Sep-14 27-Sep-14 30-Sep-14 -3
730 0 Architectural 14-Sep-14 Gap between Spandrel Glass Curtain Wall and Corewall 15-Sep-14 29-Sep-14 30-Sep-14 -1 Haddad
732 1 Mechanical 21-Sep-14 Requirment of Water Heater & Water Supply at 69th Floor 21-Sep-14 5-Oct-14 30-Sep-14 5
733 0 Architectural 14-Sep-14 Paint Color Finishes - Parking levels and corridor at non-branded floors 15-Sep-14 29-Sep-14 30-Sep-14 -1
RE /
letter send to damac
735 0
Architectural /
Structural
18-Sep-14 L86 - Slab System BMU - Connection Details 18-Sep-14 2-Oct-14 30-Sep-14 2
To Ramboll
21.09.2014
736 0 Mechanical 21-Sep-14 Parking Drain Location at Podium 2 21-Sep-14 5-Oct-14 30-Sep-14 5
740 0 Mechanical 25-Sep-14 AC Design Drawing for Typical Floors (43rd to 55th floors) 25-Sep-14 9-Oct-14 30-Sep-14 9
739 0 Architectural 25-Sep-14 Block Wal near fire hose cabinet at corridor 2 25-Sep-14 9-Oct-14 30-Sep-14 9
737 0 Architectural 29-Sep-14 Façade Light cabling arrangement for UCW corner panels 29-Sep-14 13-Oct-14 30-Sep-14 13
743 0 Architectural 30-Sep-14 Inaccessible Telephone Room at level 86 30-Sep-14 14-Oct-14 30-Sep-14 14
741 0 Structural 30-Sep-14 Missing lines of RC slanted columns ends at SSL of level 62 30-Sep-14 14-Oct-14 30-Sep-14 14
Legend
Under AECOM Review
Under Contractor Preparation
Overdue (Review)
File:- Page2 of 2 Printed On:12.10.2014 at 07:12
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 14
Outstanding Shop
Drawings
Outstanding Shop Drawings
TR.No. Rev.
Drawin
g No.
Dwg
Rev.
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Description Discipline From To
Date of
Receipt
Due for
Response
Current
Date
Days
Pending
Date Returned Action code
0326 05 ATC F07 SD 1087 05 Slab Edges of Level-8 Structural Arabtec Reuben 19-Mar-14 02.Apr.14 30-Sep-14 30.Mar.14 NA
0328 12 ATC F09 SD 1088 05 Slab edges of level 9 Structural Arabtec Reuben 19-Mar-14 02.Apr.14 30-Sep-14 30.Mar.14 NA
0328 12 ATC F10 SD 1089 05 Slab edges of level 10 Structural Arabtec Reuben 19-Mar-14 02.Apr.14 30-Sep-14 30.Mar.14 NA
1399 01 ATC GF SD
1174
1175
01 Ground floor to podium-5 staircase-1 Plans & Sections (Sheets 1 & 2) Structural Arabtec Reuben 7-Apr-14 21.Apr.14 30-Sep-14 24.Apr.14 No status
1400 01 ATC GF SD 1180 01 Ground Floor to Podium-5 Staircase-2 Plan & section (Sheets 1 & 2) Structural Arabtec Reuben 7-Apr-14 21.Apr.14 30-Sep-14 24.Apr.14 No status
1503 04 ATC F08 SD 1185 04 Level 8 - General Arrangement Plan and Sections (Sheet 1 of 2) Structural Arabtec Rueben 13-Mar-14 27.Mär.14 30-Sep-14 30.Mar.14 NA
1503 04 ATC F08 SD 1185 04 Level 8 - General Arrangement Plan and Sections (Sheet 2 of 2) Structural Arabtec Rueben 13-Mar-14 27.Mär.14 30-Sep-14 30.Mar.14 NA
1801 02 S01 P5 SD 2579 02 Wall W-01 reinforcement detail (Zone A1) Lvl +25.550 to Level 6 Structural Arabtec Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 NA
1801 02 S01 P5 SD 2580 02 Wall W-01 reinforcement detail (Zone A1) Lvl +25.550 to Level 6 Structural Arabtec Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 NA
1801 02 S01 P5 SD 2590 02 Wall W-02 & Wing Walls Reinforcement detail (Pouring 2) Lvl +25.550 to Level 6 (sheet 1 of 2) Structural Arabtec Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 NA
1801 02 S01 P5 SD 2591 02 Wall W-02 & Wing Walls Reinforcement detail (Pouring 2) Lvl +25.550 to Level 6 (sheet 2 of 2) Structural Arabtec Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 NA
1801 02 S01 P5 SD 2794 00 Wall (W-2, W-4,W-6, W-8,9) Reinforcement Details Podium-5 to Level-6 (Sheet 5 of 5) Structural Arabtec Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 NA
1808 02 S01 P5 SD 2561 02 Wall (W02, W04, W06, W08 & W09) Reinforcement Details Podium-5 to +25.550 (Sheet 1 of 2) Structural CICON Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 AAN & RR
1808 02 S01 P5 SD 2562 02 Wall (W02, W04, W06, W08 & W09) Reinforcement Details Podium-5 to +25.550 (Sheet 2 of 2) Structural CICON Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 AAN & RR
1808 02 S01 P5 BBS BBS for the above mentioned drawing. Structural CICON Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 AAN & RR
2007 01 S01 B3 SD
2735
2736
01
Column - Zone B (B3 to U/s B2) Reinforcement Detail PC-25, PC-26, PC-27 & PC-17 (Sheet 1 of
4) Column - Zone B (B3 to U/s B2) Reinforcement Detail PC-23, PC-24, PC-16 & PC-18
(Sheet 2 of 4)
Structural CICON Reuben 18-Sep-14 02.Okt.14 30-Sep-14 2
2108 00 ATC GEN SK 623 00 Podium-5 Secondary Slab Structural Arabtec Junaid 16.01.2014 30.Jän.14 30-Sep-14 19.Jan.14 NA
2118 01 S16 PD4 SD 15609 01 Podium-2 Floor Plan voice/Data Layout. Electrical REMCO Zahid 02.02.2014 16.Feb.14 30-Sep-14 5.Feb.14 NA
2118 01 S16 PD7 SD 15612 00 Podium-3 Floor Plan voice/Data Layout. Electrical REMCO Zahid 02.02.2014 16.Feb.14 30-Sep-14 5.Feb.14 NA
Fw to
2230 01 S16 B02 SD 15103 01 Basement 2 floor plan lighting layout Electrical REMCO
AECOM on
27.02.2014 13.Mär.14 30-Sep-14 18.Mar.14 NA
2230 01 S16 B01 SD 15104 01 Basement 1 floor plan lighting layout Electrical REMCO
Fw to
AECOM on
27.02.2014 13.Mär.14 30-Sep-14 18.Mar.14 NA
2238 00 S16 F22 SD 16521 00 22nd floor plan water supply layout Mechanical REMCO Basel 02.02.2014 16.Feb.14 30-Sep-14 15.Feb.14 NA
2276 01 S16 F13 SD 15314 01 Level 13th floor plan Emergency and Exit Lighting Layout. Electrical REMCO Zahid 13-Feb-14 27.Feb.14 30-Sep-14
2324 00 S16 F20 SD 16620 00 Typical (20th & 21st Floor Drainage Layout) Mechanical REMCO Basel 13.02.2014 27.Feb.14 30-Sep-14 26.Feb.14 NA
2325 00 S16 F13 SD 15114 00 Level - 13th floor plan lighting layout. Electrical REMCO Zahid 13.02.2014 27.Feb.14 30-Sep-14 19.Feb.14 NA
2395 01 S16 B05 SD 16500 01 Basement-5 Plan Sheet 1 of 2 Water Supply layout (Sheet 1 of 2) Mechanical REMCO Aiman 18.03.2014 01.Apr.14 30-Sep-14 18.Mar.14 NA
2395 01 S16 B05 SD 16500 01 Basement-5 Plan Sheet 1 of 2 Water Supply layout (Sheet 2 of 2) Mechanical REMCO Aiman 18.03.2014 01.Apr.14 30-Sep-14 18.Mar.14 NA
2395 01 S16 B04 SD 16501 01 Basement-4 Plan Water Supply Layout Mechanical REMCO Aiman 18.03.2014 01.Apr.14 30-Sep-14 18.Mar.14 NA
2395 01 S16 B03 SD 16502 01 Basement-3 Plan Water Supply Layout Mechanical REMCO Aiman 18.03.2014 01.Apr.14 30-Sep-14 18.Mar.14 NA
2395 01 S16 B02 SD 16503 01 Basement-2 Plan Water Supply Layout Mechanical REMCO Aiman 18.03.2014 01.Apr.14 30-Sep-14 18.Mar.14 NA
2395 01 S16 B01 SD 16504 01 Basement-1 Plan Water Supply Layout Mechanical REMCO Aiman 18.03.2014 01.Apr.14 30-Sep-14 18.Mar.14 NA
2404 01 ATC F47 SD 1444 01 Slab Edges of Level-48 and coordinates Structural Arabtec Reuben 17-Aug-14 31.Aug.14 30-Sep-14 -30
2405 01 ATC F49 SD 1445 01 Slab Edges of Level-49 Structural Arabtec Reuben 19-Aug-14 02.Sep.14 30-Sep-14 -28
2406 01 ATC F50 SD 1446 01 Slab Edges of Level-50 Structural Arabtec Reuben 19-Aug-14 02.Sep.14 30-Sep-14 -28
2480 01 S01 L10 SD
3204
3205
01 BBS for the above mentioned drawing. Structural CICON Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12
00 ATC B04 DAB
2062,20
70 to
00 Slab Reinforcement details. (Total 23 drawings) - Draft As-built Structural CICON Reuben 23.02.2014 09.Mär.14 30-Sep-14 1.Apr.14 NA
2421 01 ATC
F51
F52
SD
1447
1448
01 Slab Edges of Level-51 & 52 Structural Arabtec 28-Aug-14 11.Sep.14 30-Sep-14 -19 10.Sep.14
2433 01 S01 L11 SD
3173
3174
01 Level-11 PT Slab reinforcement details top and bottom (B2 & T1) Sheet 1 to 5 Structural CICON Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12
File: Page 1 of 6 Printed On: 12.10.2014 at 09:33
Outstanding Shop Drawings
TR.No. Rev.
Drawin
g No.
Dwg
Rev.
Description Discipline From To
Date of
Receipt
Due for
Response
Current
Date
Days
Pending
Date Returned Action code
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
2434 00 ATC B03 DAB
2050 to
2115
00 Reinforcement drawings (Total 44 drawings) - As-built Structural CICON Reuben 26.02.2014 12.Mär.14 30-Sep-14 2.Apr.14 NA
2451 01 S01 L12 SD
3183
3184
01 Level-12 PT Slab Reinforcement Details Top and Bottom Structural CICON Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12
2452 01 S01 L13 SD
3194
3195
01 Level-13 PT Slab Reinforcement Details Top and Bottom Structural CICON Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12
2501 01 ATC
F58
F59
SD
1454
1455
01 Slab Edges of Level 58 and coordinates Slab Edges of Level 59 and coordinates Structural Arabtec Reuben 17-Sep-14 01.Okt.14 30-Sep-14 1
2507 S16 PD1 SD 16006-1 01 Podium 1 - 1 floor plan A/C Ventilatiomn Sections & Details Mechanical REMCO Aiman 17.04.2014 01.Mai.14 30-Sep-14 27.Apr.14 NA
2507 S16 PD1 SD 16006-2 01 Podium 2 - 1 floor plan A/C Ventilatiomn layout Mechanical REMCO Aiman 17.04.2014 01.Mai.14 30-Sep-14 27.Apr.14 NA
2507 02 S16 PD1 SD 16006 02 Podium 1 floor plan A/C Ventilatiomn layout Mechanical REMCO Aiman 08.06.2014 22.Jun.14 30-Sep-14 16.Jun.14 NA
2536 00 S16 F06 SD 16813 00 Level 6th floor plan MEP coordination layout Mechanical REMCO Aiman 12.03.2014 26.Mär.14 30-Sep-14 30.Mar.14 NA
2542 00 S16 F20 SD 15420 00 20th & 21st Foors plan (typical) fire alarm & voice evacuation layout Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 18.Mar.14 NA
2542 00 S16 F22 SD 15421 00 22nd Floor plan fire alarm & voice evacuation layout Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 18.Mar.14 NA
2543 00 S16 B05 SD 15600 00 Basement to 5th floor plan voice & data layout Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 18.Mar.14 NA
2543 00 S16 B04 SD 15601 00 Basement to 4th floor plan voice & data layout Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 18.Mar.14 NA
2543 00 S16 B03 SD 15602 00 Basement to 3th floor plan voice & data layout Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 18.Mar.14 NA
2543 00 S16 B02 SD 15603 00 Basement to 2th floor plan voice & data layout Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 18.Mar.14 NA
2553 00 S16 F14 SD 15115 00 14th & 15th levels lighting plan Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 30.Mar.14 NA
2553 00 S16 F15 SD 15116 00 16th level lighting plan Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 30.Mar.14 NA
2578 01 S16 PD2 SD 16007 01 Podium - 2 Floor Plan HVAC Layout Mechanical REMCO Aiman 04.06.2014 18.Jun.14 30-Sep-14 10.Jun.14 NA
2621 DAB ATC B01 DAB
2180 -
2201
DAB Draft as built drawings for reinforcement details - As-built Structural CICON Reuben 25.03.2014 08.Apr.14 30-Sep-14 2.Apr.14 NA
2621 DAB ATC B01 DAB
2180 -
2201
DAB Draft as built drawings for reinforcement details - As-built Structural CICON Reuben 05.04.2014 19.Apr.14 30-Sep-14 DAB DAB
2456 DAB S01 RFT DAB
2001-
2075
DAB1 Raft Lift Pit pouring - As-built Structural CICON Reuben 01.03.2014 15.Mär.14 30-Sep-14 2.Apr.14 NA
2455 DAB ATC B02 DAB
2116-
2179
DAB Slab Pouring - As-built Structural CICON Reuben 01.03.2014 15.Mär.14 30-Sep-14 2.Apr.14 NA
2434 00 ATC B04 DAB
2062,
2070-
DAB Slab & Beam pull out bar reinforcement details - Draft As-built Drawings Structural CICON Reuben 03.04.2014 17.Apr.14 30-Sep-14 DAB DAB
2434 00 ATC B03 DAB
2050-
2115
DAB Wall W-01 Reinforcement Details (pouring 2) Basement 3 - Draft As-built Drawings Structural CICON Reuben 03.04.2014 17.Apr.14 30-Sep-14 DAB DAB
2455 00 ATC B02 DAB
2116-
2179
DAB B2 Slab Pouring - 1 Reinforcement Bottom Layer B1-Draft As-built Drawings Structural CICON Reuben 03.04.2014 17.Apr.14 30-Sep-14 DAB DAB
2456 00 S01 RFT DAB
2001 -
2075
DAB1 Raft Lift pouring - 1- Bottom. Structural CICON Reuben 03.04.2014 17.Apr.14 30-Sep-14 DAB DAB
2709 00 S18
F23
F24
SD
8517
8518
00 23, 24 & 25 Floor Embedment Layout Architectural ALICO Bassem 08.04.2014 22.Apr.14 30-Sep-14 17.Apr.14 NA
2731 DAB S01 P2 DAB
2202 -
2241
DAB
Column reinforcement details A1 Part 1 Podium 2-4 Column PC-06,08,09,10,11,07,22, Slab
reinforcement details inside corewall
Structural CICON Reuben 15.04.2014 29.Apr.14 30-Sep-14 DAB DAB
2747 00 S16 F19 SD 16619 00 19th Floor Drainage Layout Mechanical REMCO Aiman 16.04.2014 30.Apr.14 30-Sep-14 22.Apr.14 NA
2748 01 S16 GFL SD
16005
16073
01 Ground Floor Plan HVAC Layout & Section Details Mechanical REMCO Aiman 17.06.2014 01.Jul.14 30-Sep-14 22.Jun.14 NA
2758 00 S21 ELV SD
5101
5102
00 Façade access system restraint socket elevation @ North East Architectural DANWAY Bassem 17.04.2014 01.Mai.14 30-Sep-14 7.May.14 NA
2785 00 S16 GFL SD 16605 00 Ground Floor Drainage Layout Mechanical REMCO Aiman 21.04.2014 05.Mai.14 30-Sep-14 29.Apr.14 NA
2819 00 S16 GEN SD 17373 00 Fire Alarm, Emergency & Exit Light Installation Electrical REMCO Faisal 28.04.2014 12.Mai.14 30-Sep-14 1.May.14 NA
2903 02 S21
F43
F48
F52
F55
SD
5114
5115
5116
5117
00
Façade access system restraint socket location plan @ 43rd and 46th floor
Façade access system restraint socket location plan @ 48th and 49th floor
Façade access system restraint socket location plan @ 52nd and 53rd floor
Façade access system restraint socket location plan @ 55th and 58th floor
Architectural DANWAY Ramon 23.08.2014 06.Sep.14 30-Sep-14 25.Sep.14 NA
2907 01 S01 L21 SD
2895
2896
01 Level 21 - PT slab reinforcement Detials top & bottom 6 sheets Structural CICON Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12
2908 01 S01 L22 SD
2919
2920
01 Level 22 - PT slab reinforcement Detials top & bottom 6 sheets Structural CICON Reuben 30-Sep-14 14.Okt.14 30-Sep-14 14
2911 00 S21 F45 SD 5118 00 Restraint Socket fixing details at transom and floor slab area Structural DANWAY Ramon 13.05.2014 27.Mai.14 30-Sep-14 29.May.14 NA
2915 00 S16
GFL
PD5
SD
16705
16710
00 Ground floor & Podium 5 Fire Fighting Layout Mechanical REMCO Aiman 13.05.2014 27.Mai.14 30-Sep-14 19.May.14 NA
File: Page 2 of 6 Printed On: 12.10.2014 at 09:33
Outstanding Shop Drawings
TR.No. Rev.
Drawin
g No.
Dwg
Rev.
Description Discipline From To
Date of
Receipt
Due for
Response
Current
Date
Days
Pending
Date Returned Action code
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
2942 00 S01 RFT DAB
2142
to
2314
DAB
DRAFT AS-BUILT DRAWINGS - raft pouring, slab pouring, corewall horizontal reinforcement,
corewall sectional elevation, corewall vertical reinforcement, etc.
Structural CICON Reuben 15-May-14 29.Mai.14 30-Sep-14
2983 00 ATC F17 DAB 1038 DAB DRAFT AS-BUILT DRAWINGS - Level 17 slab edges and coordinates Structural Arabtec Reuben 19.05.2014 02.Jun.14 30-Sep-14 22.May.14 NA
2986 00 ATC
F16
F17
F18
F19
SD
6082
6099
6100
6101
00 16,17,18 and 19 floors block wall general arrangement plan & sections details) Architectural Arabtec Ramon 19.05.2014 02.Jun.14 30-Sep-14 1.Jun.14 NA
3046 01 S01 L23 SD
2928
2929
01 Level 23 PT Slab reinforcement details top and bottom Sheets 1 to 6 Structural CICON Reuben 30-Sep-14 14.Okt.14 30-Sep-14 14
3057 00 S16 F30 SD 16030 00 Level 30th floor plan HVAC Layout (2 sheets) Mechanical REMCO Aiman 29.05.2014 12.Jun.14 30-Sep-14 5.Jun.14 NA
3066 01 S01 L24 SD
2935
2936
01 Level 24 PT slab reinforcement details top and bottom (B2 & T1) (6 sheets) Structural CICON Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12
3100 00 S16 F30 SD 16670 00 Level 30th Mechanical Floor High Level Drainage Layout Mechanical REMCO Aiman 02.06.2014 16.Jun.14 30-Sep-14 8.Jun.14 NA
3149 00 ATC GEN SD
0633
0635
0636
00 Water tank water proofing details (sheets 1 to 4) Structural Arabtec Reuben 09.06.2014 23.Jun.14 30-Sep-14 12.Jun.14 NA
3204 00 S22 WP SD 5301 00 Waterproofing details for wet area Architectural Procare Ramon 16.06.2014 30.Jun.14 30-Sep-14 7.Jul.14 NA
3254 01 S01
L26
L28
SD
3100
3279
01
Beam Reinforcement Details 26th floor beam (Sheet 1) Beam Reinforcement
Details 28th floor beam (Sheet 3)
Structural CICON Reuben 30-Sep-14 14.Okt.14 30-Sep-14 14
3267 01 S01 L29 SD
3285
3286
01 29th floor slab and beam pull out bar B2 & T1 Layer sheets 1 to 3 Structural Arabtec Reuben 30-Sep-14 14.Okt.14 30-Sep-14 14
3281 01 S01 L29 SD
3302
3303
01 Level 29 PT Slab reinforcement details top & bottom (B2 & T1) (Sheets 1 to 7) Structural REMCO Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12
3288 01 S16
F77
F80
SD
16753
16755
01
Level 77th to 79th Typical Floor Fire Fighting Layout Level 80th to 84th Typical Floor Fire
Fighting Layout
Mechanical Arabtec Raouf 10.09.2014 24.Sep.14 30-Sep-14 18.Sep.14 AAN/NA
3305 00 S16
D81
F83
F85
SD
16756
16757
16758
00
81 & 82 Typical Floor fire fighting layout 83 & 84 Typical Floor fire
fighting layout 85 floor fire fighting layout
Mechanical REMCO Aiman 28.06.2014 12.Jul.14 30-Sep-14 6.Jul.14 NA
3303 01 S16 F53 SD 16938 01 53rd Floor / slab MEP builder works layout Mechanical REMCO Aiman 02.09.2014 16.Sep.14 30-Sep-14 8.Sep.14 NA
3325 00 S16 F64 SD 16045 00 Level 64th to 66th floor plan HVAC Layout Mechanical Arabtec Aiman 30.06.2014 14.Jul.14 30-Sep-14 12.Jul.14 NA
3368 01 S16 F30 SD
16829
16865
16866
16882
01
Level 30th Floor Plan MEP Coordination (High Level) Sheet 1 of 4
Level 30th Floor Plan MEP Coordination (Low Level) Sheet 2 of 4
Level 30th Floor Plan MEP Section & Details Sheet 3 of 4 Level 30th Floor Plan MEP Section &
Details Sheet 4 of 4
Mechanical REMCO Raouf 10.09.2014 24.Sep.14 30-Sep-14 13.Sep.14 NA
3414 00 S16
F57
F63
SD
16940
16942
00
57th to 61st Typical floor / slab MEP builder works layout
63rd floor / slab MEP builder works layout 64th to 66th Typical Floor /
Mechanical REMCO Aiman 13.07.2014 27.Jul.14 30-Sep-14 21.Jul.14 NA
3418 01 S01 L30 SD
3327
3328
3329
3330
3331
01
Level 30 RC Slab reinforcement details bottom (B1) (B2), top (T1) (T2), additional bar top,
trimmer bar, punching shear details
Structural CICON Reuben 30-Sep-14 14.Okt.14 30-Sep-14 14
3475 00 S16
B05
F30
F42
F56
SD
16700
16727
16735
16739
00
Basement 5, 42nd, 56th, (57th to 61st Typical) 75th, 86th, roof & upper roof Floor Fire Fighting
layout. 30th & 62nd floors mechanical floor fire fighting layout
Mechanical REMCO Aiman 19.07.2014 02.Aug.14 30-Sep-14 31.Jul.14 NA
3475 01 S16 F62 SD 16741 01 62nd Mechanical Floor Fire Fighting layout Mechanical REMCO Raouf 10.09.2014 24.Sep.14 30-Sep-14 20.Sep.14 NA
3474 01 S01
F70
F77
SD
16547
16553
01
70th to 76th Typical Floor Plan Water Supply Layout 77th to 79th Typical Floor Plan Water
Supply Layout 84th Floor Plan Water Supply Layout
Mechanical REMCO Raouf 14.09.2014 28.Sep.14 30-Sep-14 22.Sep.14
AAN
NA
3505 00 S16 GR SD 15305 00 Ground floor plan emergency & exit lighting layout Electrical REMCO Faisal 22.07.2014 05.Aug.14 30-Sep-14 9.Aug.14 NA
3495 00 S16
F73
F75
SD
16650
16651
00 73rd, 74th & 75th Floors Drainage Layout Mechanical REMCO Aiman 22.07.2014 05.Aug.14 30-Sep-14 4.Aug.14 NA
3510 01 S03 SSW SD 4011 01 Zone 4 plan & Retaining wall section details Structural Al Shirawi Reuben 22-Sep-14 06.Okt.14 30-Sep-14 6
3537 01 S16 F85 SD 16558 01 85th Floor Plan Water Supply Layout Mechanical REMCO Raouf 23.09.2014 07.Okt.14 30-Sep-14 29.Sep.14 NA
3531 00 S16
F68
F76
SD
16645
16652
00 68th & 76th floor drainage layout Mechanical REMCO Aiman 26.07.2014 09.Aug.14 30-Sep-14 5.Aug.14 NA
File: Page 3 of 6 Printed On: 12.10.2014 at 09:33
Outstanding Shop Drawings
TR.No. Rev.
Drawin
g No.
Dwg
Rev.
Description Discipline From To
Date of
Receipt
Due for
Response
Current
Date
Days
Pending
Date Returned Action code
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
3553 00 S16 F78 SD 16654 00 78 & 79 Typical Floors draiange layout Mechanical REMCO Aiman 27.07.2014 10.Aug.14 30-Sep-14 7.Aug.14 NA
3559 00 ATC GEN SD
6212
6213
00 Typical floor corridor tiling layout plan (Sheets 1 to 7) Architectural Arabtec
Haddad /
Ramon
27-Jul-14 10.Aug.14 30-Sep-14 -51
3590 00 S25
F06
F07
SD
19301
19302
00
Drywall partition plan and details level 6 & 7 Drywall typical
details (Sheets 1 & 2)
Architectural Batimat Haddad 2-Aug-14 16.Aug.14 30-Sep-14 -45 1.Sep.14
3593 ST S01
P4 P2
GF
DAB
2423
2424
DAB Podium 4 zaone A1, zone A2 reinforcement details - DRAFT AS-BUILT DRAWINGS Structural CICON Reuben 03.08.2014 17.Aug.14 30-Sep-14 DAB DAB
3592 00 S01
GF
P1 P2
DAB
2281
2282
DAB GF, P1, P2 & P4 Slab & Beam pull out bar reinforcement details - DRAFT AS-BUILT DRAWINGS Structural CICON Reuben 03.08.2014 17.Aug.14 30-Sep-14 DAB DAB
3601 00 ATC F09 SD
6170
6171
00 Toilets tiling layout Level 9 Unit 3 (Type 11 & 16) Architectural Arabtec Haddad 3-Aug-14 17.Aug.14 30-Sep-14 -44
3600 00 ATC F11 SD 6222 00 Toilets tiling layout Level 11 Unit 4 (Type 50) Architectural Arabtec Haddad 3-Aug-14 17.Aug.14 30-Sep-14 -44
3604 00 S21
MP86
SEC-A
SD
5119
5120
00 Façade acces system machine manuevering layout at 86th floor Architectural Arabtec Haddad 04.08.2014 18.Aug.14 30-Sep-14 24.Sep.14 NA
3612 01 S16 GEN SD
16075
16076
01
Level 31st to 62nd floor Chilled Water Schematic Riser Diagram Sheets 2 to 3
Level 62nd to 88th Floor Chilled Water Schematic Riser Diagram Sheets 3 to 3
Mechanical REMCO Raouf 10-Sep-14 24.Sep.14 30-Sep-14 -6
3611 00 S01 F32 SD
3464
3465
3466
00 Reinforcement Details of Columns TC-01 & TC-02 - 32nd to U/S 34th floor (Sheets 1 to 4) Structural CICON Reuben 5-Aug-14 19.Aug.14 30-Sep-14 -42
3651 00 S25
F08
F09
SD
19303
19304
00 Drywall partition plan and details level 8 & 9 (Sheets 1 & 2) Architectural Batimat Ramon 10-Aug-14 24.Aug.14 30-Sep-14 -37 9.Sep.14
3698 01 S05 B05 SD
4225
4227
01
Zone - B Level B5 retaining wall from Axis (3) to Axis (8) formwork - Anchor layout (Sheet 1 of
2) - Pour 1 - Pour 2 - Pour 3 & 4
Structural Peri Reuben 25.08.2014 08.Sep.14 30-Sep-14 28.Aug.14 NA
3699 00 S25
F06
GEN
SD
19013
19092
19093
00 Reflected ceiling plan & details (level 06, Sheet 1 of 2) Architectural Batimat Ramon 16.08.2014 30.Aug.14 30-Sep-14 18.Aug.14 ANN/NA
3732 00 S01 L30 SD 3695 00 Level 30 RC slab foundation reinforcement details plinth & upstand for GRP water tank Structural Arabtec Reuben 20-Aug-14 03.Sep.14 30-Sep-14 -27
3739 00 S01 F40 SD
3659
3660
00 Reinforcement Detail of Wing Wall 1, 3, 5 and 7 and 2, 4, 6, 8 and 9 (Level 40-42) Structural Arabtec Reuben 20-Aug-14 03.Sep.14 30-Sep-14 -27
3736 00 S13 F42 SD
4687
4688
00 Level 42, 43 and 44 tendon profiles Structural Arabtec Reuben 20-Aug-14 03.Sep.14 30-Sep-14 -27
3741 00 S16 F30 SD
17701
17702
00 Level 30 Floor Plan - Floatinf Ref. for MEP Equipment and Foundation with out equipment
Mechancal /
Electrical
Arabtec
Ahmed /
Auday
20-Aug-14 03.Sep.14 30-Sep-14 -27
3762 01 S02 L44
SD
BSS
3700
3701
3702
3703
3704
3705
3706
3707
3708
01
Level 43 PT Slab Reinforecement Details Bottom (B1) Sheet 1 of 10
Level 43 PT Slab Reinforecement Details Top (T2) Sheet 2 of 10
Level 43 PT Slab Reinforecement Details Bottom (B2) Sheet 1 of 10
Level 43 PT Slab Reinforecement Details Top (T1) Sheet 4 of 10
Level 43 PT Slab Reinforecement Details Additional Bar Bottom & Top (T2) Sheet 5 of 10
Level 43 PT Slab Reinforecement Details Trimmer Bar, Axial Lateral Sheet 6 of 10
Level 43 PT Slab Reinforecement Details Punching Shear Links Sheet 7 of 10
Level 43 PT Slab Reinforecement Details Punching Shear Links Sheet 8 of 10
Level 43 PT Slab Reinforecement Details Section 9 of 10 Level 43 PT
Slab Reinforecement Details Post Tension Layout 10 of 10 BBS
for the above mentioned drawings
Structural CICON Reuben 22-Sep-14 06.Okt.14 30-Sep-14 6
0 00 - - - - 00 Typical Section for Micropile and PVC Pipes Structural IGS Reuben 25-Aug-14 08.Sep.14 30-Sep-14 -22
3765 00 S05 B05 SD
4226
4230
00 Zone B - Level B5 retaining wall from Axis (1 - 3) - Anchor layout, Pour 5, 6, 7 and 8) Structural Peri Reuben 25.08.2014 08.Sep.14 30-Sep-14 12.Oct.14 NA
3774 00 S01 L28 SD
3668
3669
00
Staircase 1 Reinforcement Detail Plan 28th Floor to 30th Floor Sheet 1 of 4
Staircase 1 Reinforcement Detail Plan 30th Floor to 31st Floor Sheet 2 of 4
Structural CICON Reuben 28-Aug-14 11.Sep.14 30-Sep-14 -19
3803 00 S05 L32 SD
4234
4235
4236
4237
4238
00
Slab & Beam formwork layout level 32 to 35 (Part 1) PD8/Multiplex with GT24 sheets 1 to 5
Slab & Beam formwork layout level 32 to 35 (Part 2) PD8/Multiplex with GT24 sheets 2 to 5
Slab & Beam formwork layout level 32 to 35 (Part 3) PD8/Multiplex with GT24 sheets 3 to 5
Slab & Beam formwork layout level 32 to 35 (Part 4) PD8/Multiplex with GT24 sheets 4 to 5
Slab & Beam formwork Sections & Details level 32 to 35 (Part 1) PD8/Multiplex with GT24 sheets
1 to 5
Structural PERI LLC Reuben 12-Oct-14 26.Okt.14 30-Sep-14 26 9.Sep.14
File: Page 4 of 6 Printed On: 12.10.2014 at 09:33
Outstanding Shop Drawings
TR.No. Rev.
Drawin
g No.
Dwg
Rev.
Description Discipline From To
Date of
Receipt
Due for
Response
Current
Date
Days
Pending
Date Returned Action code
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
3878 00 ATC B04 SD
1605
1606
1607
00
Slab Construction Joint Location for Zone - B from Basement - 4 to Ground Floor (Sheet 1 of 3)
Slab Construction Joint Location for Zone - B from Basement - 4 to Ground Floor (Sheet 2 of 3)
Slab Construction Joint Location for Zone - B from Basement - 4 to Ground Floor (Sheet 3 of 3)
Structural Arabtec Reuben 11.09.2014 25.Sep.14 30-Sep-14 22.Sep.14 NA
3905 00 ATC F11 SD
6273
6274
6275
00
Toilets tiling layout level-11, unit-6 (Type-T17) Toilets tiling layout level-11, unit-6 (Type-
T20) Toilets tiling layout level-11, unit-6 (Type-T18)
Architectural Arabtec Haddad 15-Sep-14 29.Sep.14 30-Sep-14 -1
3907 00 ATC F11 SD
6314
6315
6316
6317
00
Toilets tiling Layout Level-11, unit-8 Type - 42 Toilets tiling Layout Level-11, unit-8 Type - 1
Toilets tiling Layout Level-11, unit-9 Type - T2 Toilets tiling Layout Level-11, unit-9 Type - 1
Architectural Arabtec Haddad 15-Sep-14 29.Sep.14 30-Sep-14 -1
3912 00 ATC F12 SD
6293
6294
00
Toilets tiling Layout Level-12, Unit-8 (Living &
Dining Toilet) Toilets tiling Layout Level-12, Unit-8 (BR-
1Toilet)
Architectural Arabtec Haddad 16-Sep-14 30.Sep.14 30-Sep-14 0
3922 00 ATC F09 SD
6231
6232
6233
00
Toilets tiling Layout Level-9, Unit-7 (Type-40) Toilets tiling Layout Level-9, Unit-7 (Type-31)
Toilets tiling Layout Level-9, Unit-7 (Type-19)
Architectural Arabtec Haddad 16-Sep-14 30.Sep.14 30-Sep-14 0
3936 00 ATC F55 SD
1385
1386
1601
1602
00 Level 55 General Arrangement plan and sections (Sheets 1 to 4) Structural Arabtec Reuben 21-Sep-14 05.Okt.14 30-Sep-14 5
3942 00 S25
F12
F13
F14
F15
SD
19307
19308
19309
19310
00 Drywall partition plan and details (levels 12, 13, 14, 15) & and reference sheets (1 & 2) Architectural Batimat Haddad 21-Sep-14 05.Okt.14 30-Sep-14 5
3941 00 ATC F12 SD
6296
6297
6298
6299
00
Toilets tiling layout level 12 Unit 9 (Type 1) Toilets tiling layout level 12 Unit 9
(Type T2) Toilets tiling layout level 12 Unit 10 (Type 24)
Toilets tiling layout level 12 Unit 10 (Type 22) Toilets tiling layout level 12 Unit 10
(Type 23)
Architectural Arabtec Haddad 21-Sep-14 05.Okt.14 30-Sep-14 5
3940 00 ATC F56 SD
1387
1388
1608
1609
00 Level 56 General arrangement plan & sections (Sheets 1 to 4) Structural Arabtec Reuben 21-Sep-14 05.Okt.14 30-Sep-14 5
3939 00 ATC F60 SD 1610 00 Slab edges and coordinated level 60 Structural Arabtec Reuben 21-Sep-14 05.Okt.14 30-Sep-14 5
3945 00 ATC
F10
F11
SD
6308
6309
6310
6311
00
Toilet tiling layout level 10, Unit 10, Type 24 Toilet tiling layout level 10, Unit 10,
Type 23 Toilet tiling layout level 10, Unit 10, Type 22 Toilet tiling
layout level 11, Unit 10, Type 24 Toilet tiling layout level 11, Unit 10, Type 23
Toilet tiling layout level 11, Unit 10, Type 22
Structural Arabtec Reuben 22-Sep-14 06.Okt.14 30-Sep-14 6
3951 00 ATC F55 SD
1615
1616
00 Core wall plan and elevation 1 to 9 Level 55 to level 58 -(Sheets 1 to 11) Structural Arabtec Reuben 24-Sep-14 08.Okt.14 30-Sep-14 8
3787 DAB S01 B02 DAB
2149
2156
2157
2158
DAB
DRAFT AS-BUILT DRAWINGS - Level Basement 02, Basement 03 Ground, Podium 3, Podium 4,
Podium 1, & Podium 2 slab & beam pull out bar reinforcement details
Structural Arabtec Reuben 27-Aug-14 10.Sep.14 30-Sep-14 DAB
3959 00 ATC F57 SD
1389
1390
00 Level 57 General Arrangement Plan & Sections (Sheets 1 to 4) Structural Arabtec Reuben 25-Sep-14 09.Okt.14 30-Sep-14 9
3960 00 S16 F41 SD 17346 00 Level 41st floor bedroom & Living Room Ceiling Electrical Co-ordination Layout Electrical REMCO Faisal 25-Sep-14 09.Okt.14 30-Sep-14 9 29.Sep.14
3966 00 ATC F58 SD
1391
1392
00 Level 58 General Arrangement plan & sections (Sheets 1 to 4) Structural Arabtec Reuben 27-Sep-14 11.Okt.14 30-Sep-14 11
3972 00 S01 B02 SD
3763
3764
00 Columns zone B basement 2 to U/S ground floor reinforcement details ( sheets 1 to 3) Structural Arabtec Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12
File: Page 5 of 6 Printed On: 12.10.2014 at 09:33
Outstanding Shop Drawings
TR.No. Rev.
Drawin
g No.
Dwg
Rev.
Description Discipline From To
Date of
Receipt
Due for
Response
Current
Date
Days
Pending
Date Returned Action code
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
3976 00 S05 L45 SD
4244
4245
00
Slab & beam formwork layout level 41 to 49 (part 1,2,3,4 &5)PD8 / Multiflex with GT24 (Sheets 1
to 5)
Structural PERI LLC Reuben 29-Sep-14 13.Okt.14 30-Sep-14 13
3986 00 S13
F45
F46
SD
4711
4712
00 Levels 45 (Sheets 1 & 2), 46 (Sheets 1 & 2) & 47 (Sheets 1 & 2) Tendon profiles . Structural CCL Reuben 30-Sep-14 14.Okt.14 30-Sep-14 14
3985 00 ATC F59 SD
1393
1394
00 Level 59 General Arrangement Plan & Sections (Sheets 1 to 4) Structural Arabtec Reuben 30-Sep-14 14.Okt.14 30-Sep-14 14
3984 00 ATC F36 SD 6320 00 36th floor block wall general arrangment (plan & sections details) Architectural Arabtec Haddad 30-Sep-14 14.Okt.14 30-Sep-14 14
Legend
Under AECOM Review
Under Contractor Preparation
Overdue (Review)
File: Page 6 of 6 Printed On: 12.10.2014 at 09:33
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 15
Outstanding Material
Submittals
DAMAC Gulf Properties L.L.C
Outstanding Material Submittals
TR.
No.
DAMAC Heights at Dubai Marina
Rev Description Discipline
Contractor /
Supplier
Forwarded
To
Sample
Date of
Receipt
Due for
Submission
Current
Date
Days
Pending
Date
Returned
Action
code
2069 2 Motorized Fire & Smoke Dampers Mechanical Safid
Aiman / To
Damac on
No 06.Mär.14 20.Mär.14 30-Sep-14 2.Apr.14 NA
2134 2 Sound Attenuator. Mechanical REMCO
Raouf /
To DAMAC on
No 25.Sep.14 09.Okt.14 30-Sep-14 9
2347 0 Backup Rod Architectural ALICO Arkan No 16.Feb.14 02.Mär.14 30-Sep-14 23.Feb.14
2342 0 Fire Alarm System (Value Engineering) Electrical REMCO Zahid Yes 16.Feb.14 02.Mär.14 30-Sep-14 25.Feb.14 NA
2617 0 Tile Grout Architectural Sodamco Bassem Yes 25.Mär.14 08.Apr.14 30-Sep-14 20.Apr.14 NA
2788 0
Extruded Polystyrene Rigid Insulation
(Esscofoam) (35-38 Kg) m3
Structural
Teejan General
Trading LLC
Reuben Yes 21.Apr.14 05.Mai.14 30-Sep-14 10.May.14 NA
2817 0
Material Submittal for Separol FP 15 - Oil
based, anti corrosive shutter release agent
Structural Sika
Reuben /
To DAMAC on
06.05.2014 /
Yes 27.Apr.14 11.Mai.14 30-Sep-14 12.May.14 NA
2831 2
Material Sample for RAL Colour for emergency
exit doors for lifts in match with the color of
painted wall: 1. Sample from
JOTUN brand.
Architectural Toshiba
Ramon /
Haddad To
Damac on
07.08.2014 /
Yes 22.Jul.14 05.Aug.14 30-Sep-14 12.Aug.14 NA
2932 2
Foam system (Generator room)
Value engineering
Mechanical Juma Al Majid
Raouf /
To Damac on
29.09.2014
No 25.Sep.14 09.Okt.14 30-Sep-14 9
2975 1 Fire Pump Set (Value Engineering) Mechanical REMCO
Raouf /
To Damac on
29.09.2014
No 28.Sep.14 12.Okt.14 30-Sep-14 12
3012 2
Black Nero Marquina - 20mm thick polished
(Marble)
Architectural JC Maclean
Haddad /
To Damac on
24.09.2014
Yes 25.Aug.14 08.Sep.14 30-Sep-14 -22
3017 2
Beech solidwood and 44mm Thick NFR
KINGSA Door Core in White Matt PU Paint
Finish
Architectural JC Maclean
Haddad / To
DAMAC on
10.09.2014 /
From DAMAC
Yes 21.Aug.14 04.Sep.14 30-Sep-14 16.Sep.14 NA
3016 2
Beech solidwood and 54mm Thick FR
HALSPAN Door Core in White Matt PU Paint
Finish
Architectural JC Maclean
Haddad / To
DAMAC on
10.09.2014 /
Yes 21.Aug.14 04.Sep.14 30-Sep-14 16.Sep.14 NA
3026 2
Cooling Tower (Reply to Consultant
Comments)
Mechanical REMCO
Raouf / To
Damac on
08.09.2014
No 02.Sep.14 16.Sep.14 30-Sep-14 -14
3029 0
Aggregates (Crushed) 5mm Interlocking sand
& 10 to 20mm
Structural
Dubai Al Ahlia
Transport.
Reuben No 25.Mai.14 08.Jun.14 30-Sep-14 Cancelled
3039 0 MV Cables Electrical
Al Jalal Trading /
Ducab
Faisal
/ To Damac on
01.06.2014 /
Yes 26.Mai.14 09.Jun.14 30-Sep-14 4.Jun.14 NA
File: Page 1 of 3 Printed On: 12.10.2014 at 07:43
Outstanding Material Submittals
TR.
No.
Rev Description Discipline
Contractor /
Supplier
Forwarded
To
Sample
Date of
Receipt
Due for
Submission
Current
Date
Days
Pending
Date
Returned
Action
code
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
3028 0
Aggregates (Crushed) 5mm Interlocking sand
& 10 to 20mm
Structural
New Generation
Gen.Land Tpt. Co
Reuben No 26.Mai.14 09.Jun.14 30-Sep-14 Cancelled
3037 2
NAFS125 Clean Agent System (Value
Engineering)
Mechanical
Al Arabia/ Juma Al
Majid
Raouf /
To Damac on
24.08.14 /
From Damac
No 20.Aug.14 03.Sep.14 30-Sep-14 8.Sep.14 NA
3147 2 Control & Instrumentation Cables Electrical REMCO
Faisal /
To Damac on
28.09.2014
Yes 25.Sep.14 09.Okt.14 30-Sep-14 9
3161 1 False Ceiling and Drywall Partitions Architectural Batimat
Haddad / To
DAMAC on
31.08.2014 /
From DAMAC
Yes 31.Jul.14 14.Aug.14 30-Sep-14 -47
3228 1
Grade B 500B Steel Reinforcement Bar
(Deforemed) to be used in production of wheel
Structural
Arabtec Precast
LLC
Reuben / No 14.Sep.14 28.Sep.14 30-Sep-14 -2
3390 1 Cat Ladder at roof, lift pit and water tank Architectural WMS Haddad Yes 25.Aug.14 08.Sep.14 30-Sep-14 24.Sep.14 NA
3446 0
4mm thick stone-look ALUPEX -FR cladding
for podium façade
Architectural ALICO
Ramon /
Haddad / To
Damac on
No 16.Jul.14 30.Jul.14 30-Sep-14 16.Sep.14 NA
3479 3
Paint System No.1
1 Coat Kem Epoxy Primer Sealer
1 Coat Tile Clad Spray Texture Hi Build Part A
Architectural Sherwin Williams Haddad Yes 27.Sep.14 11.Okt.14 30-Sep-14 11
3551 1
Material Submittal for 250mm wide removal
painted steel grating at trenches
Architectural Arabtec
Haddad /
To Damac on
25.09.2014 /
Yes 25.Aug.14 08.Sep.14 30-Sep-14 28.Sep.14 NA
3688 0
Material submittal for non-fore rated sealant
(Alternative Supplier)
Architectural Arabtec Ramon No 14.Aug.14 28.Aug.14 30-Sep-14 7.Sep.14 NA
3689 1 Dynamic Balancing Valve (Value Engineering) Mechanical REMCO
Raouf /
To Damac on
30.09.2014
No 25.Sep.14 09.Okt.14 30-Sep-14 9
3692 0 Sanitary Ware and stainless steel kitchensink Mechanical Milano
Raouf /
To DAMAC on
18.08.2014
Yes 16.Aug.14 30.Aug.14 30-Sep-14 -31
3705 0
GL-5: Tempered Sandblasted Glass - 10mm
Thick
Architectural JC Maclean
Haddad / To
DAMAC on
10.09.2014 /
Yes 18.Aug.14 01.Sep.14 30-Sep-14 16.Sep.14 NA
File: Page 2 of 3 Printed On: 12.10.2014 at 07:43
Outstanding Material Submittals
TR.
No.
Rev Description Discipline
Contractor /
Supplier
Forwarded
To
Sample
Date of
Receipt
Due for
Submission
Current
Date
Days
Pending
Date
Returned
Action
code
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
3854 1
Light Fittings for Back of House (BOH) Areas -
Submitted for (D1) color approval
Mechanical /
Electrical
Arabtec
Raouf /
To Damac on
28.09.2014
Yes 25.Sep.14 09.Okt.14 30-Sep-14 9
3871 1
Transfer of Water Supply Riser Support
System
Mechanical Arabtec
Raouf /
To Damac on
30.09.2014
Yes 27.Sep.14 11.Okt.14 30-Sep-14 11
3930 0
Chilled, Condenser Water Treatment & Side
Stream Filtration System
Mechanical Remco Raouf Yes 18.Sep.14 02.Okt.14 30-Sep-14 23.Sep.14 NA
3931 0
GRP Pipes & Fittings (200mm Water Transfer
Line)
Mechanical Remco
Raouf /
To Damac on
24.09.2014 /
Yes 20.Sep.14 04.Okt.14 30-Sep-14 30.Sep.14 NA
3957 0
1.Pyroplex UK - Timber Fire Door Seals Tripple
Flipper 2.Pyroplex UK -
Timber Fire Door Seals for 30 and 60 minutes-
Architectural JC Maclean Haddad Yes 25.Sep.14 09.Okt.14 30-Sep-14 9
3955 0 Black Absolute Marble Architectural JC Maclean Haddad Yes 25.Sep.14 09.Okt.14 30-Sep-14 9
3956 0
1. Mirror Stainless Steel - Color Silver
2 & 3. Brushed Stainless Steel - Color : Silver
Architectural JC Maclean Haddad Yes 25.Sep.14 09.Okt.14 30-Sep-14 9
3962 0
Joinery Accessories:
1. Full Overlay Hinges
2. Half Overlay Hinges
Architectural JC Maclean Haddad Yes 25.Sep.14 09.Okt.14 30-Sep-14 9
3969 0
FCU's Acoustic Study (Level 6th to mLevel
42nd)
Mechanical REMCO
Raouf /
To Damac on
30.09.2014
No 28.Sep.14 12.Okt.14 30-Sep-14 12
3971 0
Stainless Steel Strip (To be used between
marble and porcelain tiles)
Architectural Arabtec Haddad Yes 28.Sep.14 12.Okt.14 30-Sep-14 12
Legend
Under AECOM Review
Under Contractor Preparation
Overdue (Review)
File: Page 3 of 3 Printed On: 12.10.2014 at 07:43
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 16
Outstanding
Pre-qualifications
Outstadning Pre-Qualification Submittals
2546 0
Sub contractor approval - Prequalification documents pf PT
ddesign & Inspection (m/s. CCL Engineering)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Structural ATC/CCL 13-Mar-14 27.Mär.14 30-Sep-14 16-Mar-14 NA
Legend
Under AECOM Review
Under Contractor Preparation
Overdue (Review)
Days Pending Date Returned Action code
Forwarded
To
Date of Receipt Due for Submission Current Date
TR. No. Rev. Description Discipline
Contractor/
Subcontractor/ Supplier
File:- Page 1 of 1 Printed On: 12.10.2014 at 07:17
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 17
Outstanding
Method Statements
Outstanding Method Statements
TR.No. Rev. Description Discipline
Contractor /
Supplier
To Date of Receipt
Due for
Submission
Current Date Days Pending Date Returned Action code
2273 0 Method Statement for Bitumen Protective Coating Application. Architecutural Arabtec Arkan 06.Feb.14 20.Feb.14 30-Sep-14 11.Feb.14 AAN & RR
2312 2 Method Statement for installation of Structured Cabling System Electrical REMCO Faisal 08.Apr.14 22.Apr.14 30-Sep-14 20.Apr.14 NA
2328 0 Method Statement for installation of plate heat exchangers Mechanical REMCO Basel 13.Feb.14 27.Feb.14 30-Sep-14 26.Feb.14 NA
2510 1 Method Statement for Installation of Cooling Towers Mechanical REMCO Aiman 21.Sep.14 05.Okt.14 30-Sep-14 23.Sep.14 NA
3386 1
Method statement for fabrication, erection and installation of roof steel
structure
Structural Arabtec Reuben 28.Aug.14 11.Sep.14 30-Sep-14 06.Aug.14 NA
3388 1 Method statement for dismantling and re-erection of tower crane TC # 2 Structural Arabtec Reuben 21.Sep.14 05.Okt.14 30-Sep-14 5
3751 0 Method Statement for Installation of BMU Systems Structural Danway Reuben 21.Aug.14 04.Sep.14 30-Sep-14 02.Sep.14 NA
Legend
Under AECOM Review
Under Contractor Preparation
Overdue (Review)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
File: Page 1 of 1 Printed On: 12.10.2014 at 06:33
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 18
NCRs Report
DAMAC Gulf Properties L.L.C
Non-Conformance Report Register
DAMAC Heights at Dubai Marina
NCR No. ATC Replied Date
AECOM Response
Date
009 Pile Head Repair. GCI ZETAS 20-Oct-12
071 Defects on level 12 AECOM ATC 19-May-14 9-Sep-14
074 Defects on Level 16 AECOM ATC 10-Jun-14 5-Jul-14 7-Jul-14
083 Concrete Defects on Podium AECOM ATC 26-Aug-14
085 Core wall, Column and Slab edge not within tolerance AECOM ATC 26-Aug-14
087 Improper storage of GI Duct at P4 AECOM ATC 27-Aug-14 16-Sep-14
090 Core wall, Column and Slab edge not within tolerance AECOM ATC 26-Aug-14
096 DEWA and Shop Drawing AECOM ATC 14-Sep-14
099 FCU Storage on Site AECOM ATC 16-Sep-14 29-Sep-14 30-Sep-14
100 Concrete Defects on Level 30 AECOM ATC 17-Sep-14
101 Concrete Defects on level 31 AECOM ATC 23-Sep-14
102 FCU installed on site AECOM ATC 23-Sep-14
104
Application of waterproofing at level 8 not as per
product recommendation
AECOM ATC 28-Sep-14
O
Title Engineer Issued To Date Issued Status
File: Page 1 of 1 Printed On :- 12.10.2014 at 12:30
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 19
Actions Log
Project Issues / Actions Log as of 30 September 2014
Issue
No.
Date
Identified
Opened
By
Trans.
No.
Double
Click
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Issue Description Owner Client
Input?
Original
Due Date
Revised /
Closed
Date
Variance
(Calendar
Days)
RAGC Recommended Solution(s) / Alternative(s)
General Aspects
G001 AECOM Updated Building Permit with the revised conditions (Related to DCD approval on level P5) RME Yes Closed
Updated Building Permit with the revised conditions (Related to DCA NOC for building height) AECOM No Closed
Updated Building Permit with the revised conditions (Related to Structural Steel Shop Drawing
Approval)
ATC/Notr No Low
Item 3: Related to Structural Steel Shop Drawing
Approval: Condition to be cleared prior to
commencement of the related work above lev el 84.
Updated Building Permit with the revised conditions (Related to Letter of appointment for Notre
Dame Steel)
ATC/Notr No Low
Item 4: Related to Letter of appointment for Notre
Dame Steel: it will be submitted when the shop
drawings are ready. Condition to cleared prior to
commencement of the related work.
Updated Building Permit with the revised conditions (Related to External paving) ATC No Low
Item 5: Related to External paving: to be approved
prior to Building Completion Certificate application.
Updated Building Permit with the revised conditions (Related to Thermal insulation approval
from DM and ventilation for Chillers)
AECOM/D
M
No Closed
Updated Building Permit with the revised conditions (FIC final approval)
AECOM/D
M
No Closed
Nominations of PS items
FENDI Flats
N001 DAMAC Fit Out DAMAC 13.Nov.14 Med
N002 DAMAC
Light fittings
DAMAC 22.Mär.15 Low
N003 DAMAC
Shower enclosures
DAMAC 13.Nov.14 Med
Ground Floor
N004 DAMAC
Fit-out for the main entrances of branded and non-branded
DAMAC 07.Mai.15 Low
N005 DAMAC
FF & E
DAMAC 07.Mai.15 Low
N006 DAMAC
Light fittings
DAMAC Low
P5 - Life Style
N007 DAMAC
P5 fit out
DAMAC 29.Dez.14 Med
N008 DAMAC
P5 light fittings
DAMAC Med
N009 DAMAC
FFE of lifestyle
DAMAC 29.Dez.14 Med
N010 DAMAC
P5 Lockers
DAMAC 30.Mär.15 Low
N011 DAMAC
P5 Jacuzzi & Steam Sauna
DAMAC 12.Feb.15 Low
N012 DAMAC
P5 Acrylic panel enclosure for Jacuzzi
DAMAC 30.Jul.15 Low
N013 DAMAC
Swimming pool package
DAMAC 20.Aug.14 High
N014 DAMAC Swimming Pool Furniture DAMAC Low
General
Façade lighting
N015 DAMAC
DAMAC 24.Feb.14 High
N016 DAMAC
Metal doors
DAMAC 26.Aug.14 Closed Has been nominated on 26 Aug-14.
N017 DAMAC
Timber Doors
DAMAC Closed There are no timber doors in the corridors.
N018 DAMAC Internal/ external Signage DAMAC 20.Apr.15 Low
Issues - Actions Log Page 1 of 3 Printed on: 13.10.2014 at 12:17
Issue
No.
Date
Identified
Opened
By
Trans.
No.
Double
Click
Issue Description Owner Client
Input?
Original
Due Date
Revised /
Closed
Date
Variance
(Calendar
Days)
RAGC Recommended Solution(s) / Alternative(s)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Project Issues / Actions Log as of 30 September 2014
Structural Works
S001 AECOM Zone B de-strutting sequencing and design (Variation to the scope). AECOM 15.Okt.14 High
AECOM to propose the sequencing (Variation to the
scope).
S002 ATC
Structural steel framing at P5 to 6 floor and mechanical floors not updated (reference FAC
drawings).
DAMAC Closed
ALICO produced the design of secondary steel
structure.
S003 ALICO Slab edge clashes with the façade various upper levels 69,70 and 71.
ALICO/ATC/
RME
Med
ATC/ALICO has to advice which cut out to follow @
level 69,70 and 71.
S004 AECOM Leaks along diaphragm walls are causing delays to enabling works in raft, section B.
AECOM/DA
MAC
High Allow IGS to contain the leaks.
S005 AECOM Seepage through a hole in the diaphragm wall occurred in section DD.
AECOM/DA
MAC
15.Okt.14 High
AECOM to submit proposal to have permanent
solution to the diaphragm wall.
S006 ATC Water proofing membrane for Landscaping area has to be changed
AECOM/DA
MAC
Closed
Material submitted by ATC and it is approved.
Architectural Works
A001 DAMAC Service access doors assessment. DAMAC High
Supplier will submit the material submittal to DAMAC
approval.
A002 ATC Lift Lobby Marble to be finalized.
AECOM/DA
MAC
Med
ATC submitted prices and samples and
AECOM/DAMAC to review and advice.
A003 ATC Corridor tiles ATC Med Tiles ordered by ATC. Mock up to be done.
A004 DAMAC (Skim coat + paint) vs. (plaster and paint) cost savings comparison was submitted by ATC. DAMAC Low DAMAC to decide.
A005 DAMAC Paint: Select another supplier instead of ''Sherwin Williams''
AECOM/DA
MAC
Closed
A006 ATC RFI 572 – Approved Kitchen Equipment’s Catalogue or Technical information and installation DAMAC Closed
Catalogue was provided. ATC to follow the IFC
drawings.
A007 ATC RFI 656 – Bedroom Door – Marble Threshold Under the Door DAMAC Closed
A008 AECOM Material Submittal 3445 - Glass for Balustrade and Glass Fin ATC Closed Sample is approved on 14-Septembe-14.
A009 ATC The IFC for level 43 to 55 issued without doors and internal finishes schedules. RME Closed IFC submitted by RME.
A010 AECOM Mock up for tiling works ATC High
ATC to expedite the mock up to enable the work to
progress in line with the programme of work.
A011 AECOM Lack of progress in False Ceiling installation. ATC High
ATC to expedite the work to progress in line with the
programme of work.
MEP and Specialists Works
M001 AECOM Cooling Towers material submittal approval. DAMAC Closed Material submittal is approved on 6-Aug-14.
M002 REMCO
D14 and D29 VE items to be finalized commercially.
D14:Chilled Water Pump
D29: Corridor Pressurization
ATC Closed
M003 08.Jul.14 Phoenician Swimming pool plant design Phoenician Med
Awaiting pool designer's full design package to be
issued in order to allow DAMAC to proceed with the
nomination.
M004
Jobian
Concept
Water feature design (the scope of the services is within LON of the hard and soft landscape
nomination however there is no design i.e. shape height etc..)
RME Med
DAMAC/Ramboll input is required.
M005 REMCO Cost savings for PIR/ GI ducting ATC Closed
M006 ATC
Lack of ID-IFC drawings for GF,P5,69th and 70th floors withhold issuing the sanitary wares
purchase order.
DAMAC Med
DAMAC input is required to issue ID package with
Toilet accessories details and then DAMAC has to
issue the nomination for sanitary ware in these floors.
M007 ATC There are missing electrical points in floors 43rd and above RME Closed
M008 AECOM
AECOM advised that level P5 ( F.F. / F.A.) has been submitted to DCD however Ramboll Arch
drawing should be updated in line with DM requirements.
RME Low
Ramboll to update the architectural drawings for level
P5.
Issues - Actions Log Page 2 of 3 Printed on: 13.10.2014 at 12:17
Issue
No.
Date
Identified
Opened
By
Trans.
No.
Double
Click
Issue Description Owner Client
Input?
Original
Due Date
Revised /
Closed
Date
Variance
(Calendar
Days)
RAGC Recommended Solution(s) / Alternative(s)
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Project Issues / Actions Log as of 30 September 2014
M009 AECOM DEWA submittal pending renewal NOC for power allocation.
AECOM/DA
MAC
High
AECOM/DAMAC are following up with Emmar for the
NOC letter addressed to DEWA.
M010 AECOM
Balcony rain water risers coordination with the façade.
DAMAC Low
Proposal was submitted to DAMAC.
M011 AECOM
RCP plans / MEP Services in Non False Ceiling Area at Living / Dining & Bedrooms (L 6 - L38).
RME Closed
M012 AECOM
MEP discrepancies in the typical floors (Level 43-84).
RME Closed
M013 AECOM
Discrepancies in Lift machine rooms at Level 63-68 .
RME Closed
M014 AECOM
Missing Electrical points (Level 43 and above).
RME Closed
M015 AECOM
Electrical Load Schedule.
RME Closed
M016 ATC Re-nomination of sanitary wares to be done by DAMAC. DAMAC Med
DAMAC to re-nominate the package.
M017 AECOM LPO for Bus Bars and LV Panels. REMCO High
REMCO has to Release the LPO for Bus Bars and LV
Panels
Façade Works
F001 ALICO Composite panel mock up approval pending. DAMAC Closed Color is selected by DAMAC.
F002 DAMAC Stone Cladding/ composite cladding. ATC Low
DAMAC advised that the decision is to proceed with
stone cladding. Sample sent to ATC.
F003 ATC Openings in level 86 have to be given for BMU operation. ALICO Med
ALICO to provide opening provisions in coordinations
with BMU requirments.
F004 ATC Areas that arent accessable for glass replacement at SE and NW elevations. ATC Med
ATC to coordinate with ALICO and Danway to
propose a solution.
F005 AECOM Production and shop drawings for secondary steel structure. ATC High
ATC to submit the shop drawings for approval in
order to proceed with releasing the purchase order.
This Week's totals
Total 11 High
64 15 Med
15 Low
23 Closed
Issues - Actions Log Page 3 of 3 Printed on: 13.10.2014 at 12:17
QATAR
ACCOUNT
MANAGEMENT
PROGRAM
Damac Heights
Appendix 20
AECOM’s Organization
Chart
AECOM Organization Chart
DAMAC Gulf Properties L.L.C
DAMAC Heights at Dubai Marina
Electromechanical Architectural Structural
Electromechanical Architectural Structural
Project Director
Peer Review Team Fuad Hasan
(Abu Dhabi)
Resident Engineer
Radhi Mohamed
Document Controller
Abdul Latheef
Sr. Electrical Engineer
Planning Manager
Project Secretary
Abdulla Muhyideen
Sr. Architect
Sr. Structural Engineer
Sr. HSE Officer
MEP Manager / Mechanical
Ahmed Raouf
Hasan Abuhaiba
Stakeholder Manager
Legend
Management Staff
Supervision Staff
Helath and Safety Project Control
Documents Control
Documents Control Helath and Safety Project Control
Mateen Khawajah
Sameh Kandil
Ayman Haddad
Reuben Samaniego
Mohammad Faisi
Mechanical Inspector
Percival Vicente Architectural Inspector
Electrical Inspector
Shibu Mathew
Sanat Rane
Architectural Inspector
TBA
Structural Inspector
Roberto Magtira
Structural Inspector
Frederick Abellar
Prepared by
AECOM Middle East Limited
PO Box 51028, Dubai
United Arab Emirates
www.aecom.com
© AECOM 2014
This document is the property of AECOM and DAMAC.

Monthly Progress Report - September 2014

  • 1.
    Monthly Progress Report DAMAC Heights at Dubai Marina Report No.7 - September 2014 Submitted to DAMAC Gulf Properties Co. LLC P.O.BOX 2195, Dubai United Arab Emirates
  • 2.
    Monthly Progress Report- September 2014 Prepared for Damac Properties Co. LLC P.O.Box 2195, Dubai United Arab Emirates Prepared by AECOM Middle East Limited ايست ليمتد ϝ وم ميد Ϝ اي PO Box 51028, Dubai United Arab Emirates www.aecom.com 30.Sep.14 © AECOM 2014 The information contained in this document produced by AECOM Middle East Limited is solely for the use of the Client identified on the cover sheet for the purpose for which it has been prepared and AECOM Middle East Limited undertakes no duty to or accepts any responsibility to any third party who may rely upon this document. All rights reserved. No section or element of this document may be removed from this document, reproduced, electronically stored or transmitted in any form without the written permission of AECOM Middle East Limited. Quality Information Document Monthly Progress Report - September 2014 Ref Date 16.Okt.14 Prepared by Sameh Kandil Reviewed by Revision History Fuad Hasan/Tareq Al Emam Authorised Name/Position Signature Project Director Revision Revision Date Details 0 16.Okt.14
  • 3.
    2 Table ofContents Monthly Progress Report No. 7 - September 2014 Project Description 4 Tower Statistics 4 Project Stakeholders 4 Executive Summary 5 Key Accomplishments 6 Key Focus Issues 7 Area of Concerns 8 Contract Summary 10 Milestones 11 Upcoming Activities - 30 Day Look Ahead 13 Dashboard Reports 16 Schedule Progress 17 Negative Float Contour 21 Progress Photographs 23 Health, Safety and Environment 29 Engineering 31 Quality Assurance and Control 33 Commercial Status 35 Risk Management 37 Core Values into Practice 38 AECOM Core Values 39 Core Values into Practice 40 Appendices 42 Appendix 1: Schedule Update (Target Completion Programme-Rev3) Appendix 2: Structure Delay Appendix 3: Core Walls and Slabs Cycles Appendix 4: MEP Progress Data Sheets Appendix 5: Finishes Progress Data Sheets Appendix 6: External Facade Progress Data Sheets Appendix 7: Lifts Progress Data Sheets Appendix 8: Garbage Chute Progress Data Sheets Appendix 9: Long Lead Items Log Appendix 10: Provisional Sum Nomination Log Appendix 11: Building Permit Status Appendix 12: Technical Review Log Appendix 13: Outstanding RFIs Appendix 14: Outstanding Shop Drawings Appendix 15: Outstanding Material Submittal Appendix 16: Outstanding Subcontractors' Prequalification Appendix 17: Outstanding Method Statement Appendix 18: Non-Conformance Report Appendix 19: Actions Log Appendix 20: AECOM's Organization Chart
  • 4.
    3 Monthly ProgressReport No. 7 - September 2014 Project Description
  • 5.
    4 Project Description Tower's Statistics DAMAC Heights Tower located at plot No.A3A,392-569 at Dubai Marina and comprises of the following criteria; 141,542 m2 3,464 m2 72,899 m2 522.67 m2 335 m 6 5 79 3 1 Dates Projection Date of Commencement 19.Jun.11 Original Project Duration 1096 Original Completion Date 18.Jun.14 Forecast Project Duration 2012 Project Forecast Completion 20.Dez.16 2 Bedroom 258 3 Bedroom 86 4 Bedroom 9 5 Bedroom 2 Shops Project Stakeholders Monthly Progress Report No. 7 - September 2014 Designation 1 Main Contractor Supervision Consultant MEP Sub-Contractor Facade Sub-Contractor Building Built Up Area Plot Area Apartments Built Up Area Commercial Built Up Area Stakeholders Names Ramboll Middle East Limited ARABTEC Construction L.L.C AECOM Middle East Limited REMCO Co. L.L.C Elevators Sub-Contractor Master Developer Local Authorities DAMAC Gulf Properties Co. L.L.C Toshiba Elevator Middle East L.L.C Aluminum & Light Industries Co. (ALICO) Ltd Emaar Properties PJSC Dubai Municipality Client Consultant BMU Sub-Contractor Danway L.L.C Fit Out Sub-Contractor JC Maclean International Dubai Civil Defense DEWA Dubai Civil Aviation Etisalat Number of Flats Number of Parking Slot Number of Shops Total Tower Height Top Roof Mechanical Floors Floors 30,62,85,86,8 7,88 Area/Height Calculations Height of Tower Floors Count Basement&Ground Floors Podium Floors Typical Floors Mechanical Floors Apartment Types Rooms/Slot Count Parking Slots 649 1 Bedroom 282 637 649 1 5 335
  • 6.
    5 Monthly ProgressReport No. 7 - September 2014 Executive Summary
  • 7.
    6 Executive Summary Monthly Progress Report No. 7 - September 2014 • DuriŶg the ŵoŶth of Septeŵďer ϮϬϭϰ the projeĐt aĐtiǀities are progressiŶg. The ǁorks for the superstruĐture activities are continuing although the overall delays to the project remains. The core walls cycles as well as the slab cycles both of which are averaging (6) days. • EdžĐaǀatioŶ ǁork has stopped due to a seepage eǀeŶt that oĐĐurred oŶ ϭϳ Septeŵďer, that Đaused floodiŶg iŶ the area of section DD. • The MEP ϭst aŶd ϮŶd high leǀel serǀiĐes, MEP risers aŶd proǀisioŶ for floor aŶd ǁall serǀiĐes are oŶgoiŶg. The progress has improved and the delays will be mitigated by the end of October 2014. • The fiŶishes ǁorks iŶĐludes; ďloĐk, plaster, paiŶt aŶd ĐeiliŶg are oŶgoiŶg. • The Lift ǁorks has started iŶ the loǁ zoŶe, ŵed zoŶe aŶd high zoŶe. • FaĐade ǁorks; StiĐk ĐurtaiŶ ǁall at ďalĐoŶies ĐoŶtiŶues ďLJ ALICO iŶ Ϯϯ floors ĐoŶĐurreŶtlLJ, hoǁeǀer, the uŶitized curtain wall system is delayed. Also the glass panels test is still behind schedule. • Post-TeŶsioŶiŶg paĐkage froŵ leǀel ϲϰ till leǀel ϴϰ ǁas reǀieǁed ďLJ the ϯrd partLJ aŶd returŶed ďaĐk ǁith comments to ATC during the month. • DEWA desigŶ paĐkage is oŶ hold aǁaitiŶg the reĐeipt of NOC reŶeǁal froŵ EMAAR. • ATC ǁas iŶstruĐted to proĐeed ǁith proĐuriŶg the Bus Bars aŶd LV PaŶels. • SH&E reŵaiŶs a foĐus area of iŵproǀeŵeŶt, hoǁeǀer, the projeĐt ĐoŶtiŶues ǁithout LTI. • The keLJ risk to the projeĐt reŵaiŶs the laĐk of reǀised IFC doĐuŵeŶts for all leǀels that is peŶdiŶg froŵ the desigŶ consultant and will impact the authority packages for approval. Moreover, there is a risk of seepage from the existing diaphragm walls. Focus also should be given to finalize all the pending nominations to avoid any potential delays. Key Accomplishments Key Focus Issues Construction Progress Construction Progress • There is potential delays in the structure at Level 62 (Mechanical floor) as ATC from the Engineer point of view will not be able to achieve the planned cycle (8 days) because the width of two wing walls will increase and thus the slip form will require reconfiguration. Also the double height (5300 mm) will require 2 pours to reach the full height. • The structure completion date was slipped 6 calendar days and ATC has to mitigate such delays in the forthcoming floors. • A solution has to be proposed for the diaphragm wall in order to continue the work in Zone B. • REMCO has to increase the allocated labors and supervisors. Also ATC has to increase its MEP supervisors in order to follow up and expedite REMCO progress. • REMCO has to provide the partial and full clearance to commence the plaster and ceiling work on time. Also the electrical risers work has to be improved. • Paint (primer & stucco) and ceiling progress to be imporved by ATC. • ALCIO has to improve the curtain wall installation. • Clearance for sequencing of work to be done to avoid NCRs and stoppage of progress. • ATC to expidite the progress of Substation's finsihes and MEP works. Schedule Progress • ATC has to detail the external facade and lift work packages in order to enable the Engineer to monitor and control these packages. • The Engineer is insisting on adding sufficient details for MEP works in the program in order to be able to monitor the MEP package. • The overall delays till end of September 2014 is 182 days due to the delay in nomination of facade light package, however, the Engineer is of the view that the facade light nomination will not affect the project completion date, as the light fixtures will be installed before the project completion, which means there is sufficient time for procurement and engineering. Structure •The Slabs were poured up to level 36 and core walls were poured up to level 38. The stairs were poured till level 28. • The average cycles are 6 days for core walls and slabs. • The work in zone B was suspended due to the seepage event. However, secant piles breaking is going on in section BB progressing 81% complete. MEP • MEP High Level works are progressing in levels B5,B4,B3,B2 and 6 till 31. • MEP concealed works are progressing from level 6 till 24. • MEP risers- HAVC are progressing from level 6 till 22. • MEP risers- Fire Fighting are progressing from level 6 till 18. • MEP risers- Plumbing are progressing from level 6 till 31. • MEP risers- Electrical are progressing from level 6 till 19. • MEP ceiling clearance are progressing from level 6 till 9. Finishes • Block work is progressing from level 6 till 29. • Doors sub frames and plaster works are progressing from level 6 till 22. • Paint work is progressing from level 6 till 14 and false ceiling started in level 6. External Facade • ALICO started the installation of Stick frame curtain wall for balconies from level 6 till 28. Also the brackets for Unitized system and balcony balustrade started from level 6 to 8. Lifts • Toshiba started the preliminary works and separator steel beams in the low, med and high zones. Garbage Chute • Garbage Chute mock up was done at level 6.
  • 8.
    7 Monthly ProgressReport No. 7 - September 2014 Key Accomplishments Key Focus Issues Schedule Progress Health, Safety and Environment Engineering • PT shop drawings for levels (64-84) are under ATC review in order to resubmit it again to the 3rd Party for approval. • The LV shop drawings are ready for submission to DEWA, however, DEWA asked for design NOC's renewal before going further with drawings submission for review. • ATC continues preparing the shop drawings for false ceiling. • AECOM is preparing a proposal to have a permanent solution to the diaphragm wall. • ATC is preparing the fabrication drawings for the secondary steel structure of level 5. • A proposal for balcony rain water risers was submitted to Damac. • Approval has been obtained for FF and FA of level 5 from Civil defense and DM. • AECOM is working to provide Zone B's de-strutting sequencing. • Material submittal for intercom system, MV switch gear, generator and laminated Glass for Balcony Partition were approved. • DAMAC advised that the decision is to proceed with stone cladding and a sample sent to ATC. • An instruction was given to ATC to proceed with procuring the Bus bars and LV Panels. • The purchase order issued for Corridors tile. Quality Assurance and Control • 98 NCRs were issued to date and 85 of them are closed. • 8 NCRs were issued during this month. Commercial Status • The flooding delay events are still under review by 3rd party. No action is possible on ATC's claims until such time as the EOT decision is reached. • Variations submission, assessment and approval continues. • AECOM asked ATC to submit the PI insurances. • Payment Certificate (IPC) for August 2014 is under review. Procurement • RME has to release the Steam and Sauna package. • DAMAC has to finalize the nomination of façade light. • DAMAC to re-nominate the sanitary wares package. • ALICO to provide the factory production progress report showing the status of fabrication and the expected delivery dates. • ALICO to expedite the delivery of Cladding Panels and Unitized Curtain Wall System. • REMCO has to issue the purchase order of the Bus bars and LV Panels. Quality Assurance and Control • ATC has to improve the quality of concrete works. • ATC has to give the structural clearance before the commencement of MEP works. • ATC to improve quality of submittals to avoid ,multiple re-submission. Procurement Commercial Status • Final concluded report of flooding events has to be issued by DAMAC in order to enable Arabtec to issue a revised clause 14 that will reflect the new completion date. • Processing of agreed variations. • Processing of contractor IPCs in line with the contractual time frame. • ATC issued the Target Completion Programme - Rev 3 and it is under the Engineer's review. The comments will be issued to Arabtec by 2nd week of October 2014. Health, Safety and Environment • More work has to be done regarding the overhead protection. • House keeping needs improvement by ATC. • Excavation at sections B-B and D-D is a high risk activity. • Water Seepage at section DD and BB has to be monitored closely. • ineffective pest control in the project site offices. • Emergency escape route from level 27 to level 30 is inadequate. • More work has to be done to control the dust of Garbage Chute. •10 site observation were closed during the month of September 2014 and 2 notices were issued. • Number of first aid cases in September 2014 was (2) and (3) cases were recorded for near misses and (0) cases for LTI. • 308 orientation for new hires and 195 tool box talk were done during September 2014. Engineering • PT drawings for levels (64-84) has to be resubmitted by ATC for review. • Ramboll to provide updated drawings considering the missing electrical points for level 43 and above. • ATC to issue fabrication drawings for secondary steel structure for P5. • AECOM to prepare a proposal to have a permanent solution to the diaphragm wall. • AECOM to propose the sequencing of de-strutting for Zone B. • Ramboll to update the RCP plans considering the existing MEP provisions and the bulkhead dimensions for levels 6 till 38. • Arch and MEP design drawings (IFC) for Fendi floors from Level 43 to Roof has to be finalized. • ATC/ALICO to advice about the slab edge clashes with the façade various upper levels. • Pool designer's full design package to be issued in order to allow DAMAC to proceed with the nomination. • Emaar NOC has to be obtained in order to enable the submission of LV drawings to DEWA. The Renewal of design NOC can't be obtained without Emaar NOC.
  • 9.
    8 Area ofConcerns Area of Concern & Impact if Action not made 1 2 3 4 5 6 7 8 9 10 Lack of proposal for a permanent solution to the diphragm wall: Impact: Prolongation for the work suspension in Zone B. Lack of MEP's IFC revised drawings from Ramboll from level 43 and above: Impact: Delay in relevant shop drawings and thus delays to obtain DEWA approval for the shop drawings /schedule of loads and delays in procuring LV panels and Bus bars. Lack of Façade and Lifts detailed activities in the target completion schedule: Impact: Prevents AECOM from identifying the Façade and Lifts critical activities for the project delivery. Also prevents AECOM from closely monitoring the progress at site. Monthly Progress Report No. 7 - September 2014 Required Date 10.Okt.14 15.Okt.14 DAMAC/Ramboll 30.Okt.14 Arabtec 30.Okt.14 Lack of manpower for MEP work: Impact: REMCO will not be able to give ATC the MEP clearance to start the block and plaster works on time as per TCP-rev 3. 01.Okt.14 Absence of an independent inspection agency for post tension installation: Impact: The quality of PT works may be affected. Currently ATC is not in compliance with the specifications and payment deductions will be applied in response. 30.Okt.14 Delay in submitting fabrication drawings and shop drawings for the secondry steel structure at level P5: Impact: Installation of Unitized Curtain Wall will be delayed. Delay in the installation of façade glass panels (Stick&Unitized): Impact: Potential delays to the suspended ceiling installation. 01.Okt.14 8 days Core Wall cycle will not be achieved in level 62 : Impact: Potential delays to structure completion date as the structure is on the critical bath. Responsible Impact AECOM/DAMAC 15.Okt.14 Arabtec ATC/ALICO C C C C Arabtec C ATC/REMCO Arabtec Lack of de-strutting sequencing in Zone B : Impact: Potential delays to the excavation work. 10.Okt.14 AECOM Delay in finishes and electrical works inside the substation: Impact: Potential delays for handing over the substation to DEWA and delay for the permenent power application. 01.Okt.14 ATC C C M M M
  • 10.
    9 Area ofConcerns Monthly Progress Report No. 7 - September 2014 Area of Concern & Impact if Action not made Required Date Responsible Impact 11 Critical Manageable Lack of instruction to proceed with ordering the marble for Lift Lobby: Impact: Possibility of installation delays. 15.Okt.14 DAMAC M C M
  • 11.
    10 Contract Summary Performance Indicators Measure This Month Last Month CV EV - AC EAC Variance EAC - CP Near Misses 3 * Note: 1) The Cost and Procurement sections will be frozen till approving the Target Completion Programme. 2) SPI and SV improved due to the issuing of TCP-Rev 03. Approved Claims Approved PS 0 2 26,116,726 No. of Near Misses Schedule Progress % Total Commitments 479,041,833 Variation Status Variation Approved 35 Financial Status (AED) Approved Variations Upward Trend Downward Trend No Change Residual PS Pending Effective Contract Value Gross Certified Physical % AED % AED % AED % AED % 119.845 23.6% 115.38 22.7% 75.44487 14.84% 63.693 12.5% Complete Variations AC - Actual Cost; CPI - Cost Performance Index; CP - Contract Price; CV - Cost Variance; EAC - Estimate At Completion; EV - Earned Value; NCR - Non-Conformance Report; PV - Planned Value; RFI - Request For Information; SPI - Schedule Performance Index; SV - Schedule Variance 79 * Note: The percentage value is the current amount divided by the Contract Price of AED 508,301,847. Monthly Progress Report No. 7 - September 2014 22.46% Payment Status (AED m) 9 9 26 0.85 -56.5 -157 Area Time SPI EV / PV SV Float (MS01) 0.89 -44.8 -182 EV - PV (AED m) Days Float Remaining CPI EV / AC NCR Close Out Issued/Closed 98/85 92/77 RFI Submittals % Closed 88% 86% 90% 88% Cost Quality Health and Safety Engineering 244,747,598 Variation Under DAMAC Assessment Variation Under ATC Assessment Total Procurement Major Items Variation Rejected 2 % Closed Gross and Net certified figures exclude Advance Payments. Estimate at Completion 8,177,509 5 18,378,571 Net Certified Perviously Certified Paid to Date 37,437,524 1,899,214
  • 12.
    11 Control Milestones Days Monthly Progress Report No. 7 - September 2014 Milestones TCP-Rev 3 Current Forecast Current Float Remaining Clause 14 Program 592 18-Jun-14 226 08.Aug.13 159 06.Mär.13 90% 34% 5% Nomination of PS Items (not yet nominated) Days > 5 days 0 to 5 days < 0 days Upward Trend Downward Trend Milestones TCP - Rev 3 Current Forecast Current Float Remaining Clause 14 Program -218 2-Feb-12 10 -41 3-Jun-12 80 51 21-Nov-12 35 4-Mar-13 80 44 80 -27 17-Apr-13 80 90% 34% 5% 30.Sep Permits/NOCs Status Summary Actual Issue Date 23-Jan-11 14.Nov.13 25.Nov.13 10.Jul.14 171 SC Nomination for Fit Out (Fendi Flat) SC Nomination for Sauna,Jacuzzi 13-Nov-14 13-Nov-14 3-Sep-14 1-Oct-14 Revised Appoval Required - 30.00 3.00 50.00 Variance since Aug 14 (30.00) RME/AECOM FIC Location Approval RME/AECOM Dubai Municipality Fence NOC RME SC Nomination for Fit Out (Life Style) 4-Nov-14 4-Nov-14 116 0.00 SC Nomination for Landscaping Works 20-Nov-14 Nominated SC Nomination for Swimming Pool Works 20-Aug-14 1-Oct-14 69 (30.00) 20 Ground water Discharge 08.Mai.14 Drainage Design NOC and Drawings Approval ATC 22-Jul-11 Authority NOC/Permit Anticipated Issue Date Expiry Date Days Remaining Responsible 0 to 5 days < 0 days Upward Trend Downward Trend No Change Note: Days remaining from 30 Sep 2014 to Planned Dates of TCP. Variance since Aug 14 MS03 -Producing Wild Air (till 30th Floor) 8-Mar-15 5-May-15 -50 MS02 -Completion of Structure 14-May-15 20-May-15 -4 MS01 - Project Completion 14-May-16 20-Dec-16 -182 0.00 0.00 SC Nomination for Façade Lighting 24-Feb-14 1-Oct-14 -178 No Change Note: 1) Days remaining from 30 Sep 2014 to Planned Dates of TCP. 2) Variance since Aug-14: the difference between Current forecast of Sep vs. forecast of Aug. > 5 days
  • 13.
    12 Permits/NOCs StatusSummary Actual Issue Date Anticipated Issue Date NOC/Permit Responsible 09.Jun.13 05.Mai.13 25-Mar-13 Monthly Progress Report No. 7 - September 2014 Note: Days remaining from 30 Sep 2014 to Anticipated Date > 60 days 90% 34% 5% PerforŵaŶce MeasureŵeŶt – DefiŶitioŶs 30 to < 60 days DEWA - Electrical Electrical Load Design NOC 04.Mai.15 RME/AECOM Revised Appoval Required LV Design Drawing Approval Revised Appoval Required RME/AECOM Substation / Trench Design Approval RME/AECOM Planned Value (PV) Planned value of physical works to be accomplished. Actual Cost (AC) Actual cost of works physically accomplished. Earned Value (EV) Budgeted cost of works physically accomplished. Schedule Performance Index (SPI) = EV / PV SPI represents the current efficiency of progress. A SPI >1.0 denotes you are accomplishing more than planned. A SPI <1.0 denotes you are accomplishing less than planned < 30 days Schedule Variance (SV) = EV –PV SV represents the difference between what you have accomplished and what you planned to accomplish. A positive (+) Schedule Variance denotes you are ahead of schedule. A negative (-) Schedule Variance denotes you are behind schedule. DEWA - Water Water Design NOC 24-Mar-15 RME/AECOM RME/AECOM Water Supply Design Drawing Approval Revised Appoval Required Authority Days Remaining Expiry Date Revised Appoval Required Dubai Civil Defense Design Drawing Approval Revised Appoval Required RME/AECOM
  • 14.
    13 Upcoming Activities- 30 Days Look Ahead C 14 Monthly Progress Report No. 7 - September 2014 Activity Type Start Finish Activity Slab L37 - Completion Slab L38 - Completion Slab L39 - Completion Slab L40 - Completion 08.Okt.14 12.Okt.14 16.Okt.14 28.Okt.14 Slab L41 - Completion Slab L42 - Completion Core Wall L41 - Completion Core Wall L42 - Completion Core Wall L43 - Completion Block Work Completion-L18 08.Okt.14 18.Okt.14 23.Okt.14 29.Okt.14 5-Oct-14 17-Oct-14 29-Oct-14 2-Oct-14 16-Oct-14 24-Oct-14 Block Work Completion-L27 Block Work Completion-L28 Block Work Completion-L29 Block Work Completion-L30 Block Work Completion-L31 Plaster Work Completion-L20 Plaster Work Completion-L22 Plaster Work Completion-L23 24-Oct-14 Plaster Work Completion-L24 Plaster Work Completion-L25 3-Oct-14 10-Oct-14 29-Oct-14 Plaster Work Completion-L21 21.Okt.14 03.Nov.14 Core Wall L39 - Completion 13.Okt.14 Core Wall L40 - Completion Construction 31-Oct-14 2-Oct-14 2-Oct-14 2-Oct-14 3-Oct-14 Paint Work Completion-L6 Paint Work Completion-L7 Paint Work Completion-L8 Paint Work Completion-L9 6-Oct-14 Paint Work Completion-L10 9-Oct-14 Paint Work Completion-L11 13-Oct-14 Paint Work Completion-L12 17-Oct-14 27-Oct-14 Paint Work Completion-L15 Monthly Progress Report No. 7 - September 2014 9-Oct-14 Paint Work Completion-L13 21-Oct-14 Paint Work Completion-L14 C C C C C C C C C C
  • 15.
    Upcoming Activities -30 Days Look Ahead Activity Type Start Finish Activity MEP H/L Completion - L29 C C C C ALICO, Toshiba and JC Maclean detailed work schedules will be submitted to the Engineer. Continue reviewing ATC's new shop drawings submittals. 30-Oct-14 31-Oct-14 Finalize the open/overdue shop drawings submittals. PT drawings for levels (64-84) will be resubmitted again by ATC for 3rd party review. Ramboll to provide updated drawings considering the 25-Oct-14 missing electrical points for level 43 and above. Fabrication drawings to be submitted by ATC for the Engineer review. AECOM to propose the sequencing of de-strutting for Zone B. DAMAC/AECOM will conclude a solution to the diaphragm wall. Finalize the open/overdue material submittals. 1-Oct-14 31-Oct-14 15-Oct-14 15-Oct-14 15-Oct-14 15-Oct-14 1-Oct-14 31-Oct-14 Procurement 21-Oct-14 Unitized curtain wall will be delivered to site. Quality 1-Oct-14 LPO will be issued for Corridor Tiles. 1-Oct-14 31-Oct-14 ATC will keep closing the outstanding NCRs. 1-Oct-14 31-Oct-14 Quality Technical Meeting will be held on weekly basis to monitor the quality. 1-Oct-14 20-Oct-14 LPO for secondary steel strucutre will be issued. 1-Oct-14 20-Oct-14 RME has to release the Steam and Sauna Package. Construction 23.Okt.14 MEP H/L Completion - L31 MEP H/L Completion - L32 11.Okt.14 20.Okt.14 27.Okt.14 MEP H/L Completion - L30 Schedule 15-Oct-14 Electrical design NOC will be issued. Engineering 31-Oct-14 15-Oct-14 DAMAC will finalize the nomination of Façade Light. Re-nomination for the sanitary wares packages by DAMAC. 15-Oct-14 Continue reviewing ATC's new material submittals. C C C C C C C
  • 16.
    15 Upcoming Activities- 30 Days Look Ahead DAMAC will continue float tenders and receiving quotations for the provisional sum items. Critical Path Activity 1-Oct-14 31-Oct-14 10-Oct-14 Payment Certificate (IPC) for August 2014 will be issued. Commercial 31-Oct-14 Finalize the list of pending variations submitted by ATC. 1-Oct-14 Monthly Progress Report No. 7 - September 2014 Activity Type Start Finish Activity C
  • 17.
    16 Monthly ProgressReport No. 7 - September 2014 Dashboard R Report
  • 18.
    17 Schedule Progress Control Milestones Clause 14 Program Current Forecast Monthly Progress Report No. 7 - September 2014 -220 18-Jun-14 20-Dec-16 -182 - 3 0.00 14-May-15 -6 8-Aug-13 20-May-15 -4 3.00 -58 6-Mar-13 5-May-15 -50 5 0.00 26-Aug-13 6-Aug-15 -14 7 9.00 26-Nov-13 2-Jan-16 -46 1 0.00 -35 11-Dec-12 9-Jul-15 -28 - 4 7.00 5-Jan-13 29-Nov-14 -5 - 8.00 18-Sep-12 30-Oct-14 -57 4 .00 23-Mar-14 7-Mar-16 0 - 6.00 28-Mar-13 7-Oct-15 -28 - 3 6.00 Upward Trend Downward Trend 90% 34% 5% Milestone 60- Days look Ahead Critical Activities TCP - Rev 3 No Change Current Forecast 02.Okt.14 -6 - 6.00 08.Okt.14 -4 - 3.00 13.Okt.14 -3 - 3.00 18.Okt.14 -3 - 3.00 23-Oct-14 -5 - 5.00 29.Okt.14 -5 - 4.00 04.Nov.14 -5 - 6.00 09.Nov.14 -4 - 5.00 15.Nov.14 -4 - 6.00 22-Feb-16 31-Aug-15 2) Variance since Aug-14: the difference between Current forecast in Sep vs. forecast in Aug. Activity Slab L37 - Completion Slab L38 - Completion Slab L39 - Completion Slab L41 - Completion Slab L42 - Completion Slab L43 - Completion Slab L44 - Completion Slab L45 - Completion Total Variance 8-Mar-15 21-Jul-15 8-Nov-15 4-Jun-15 24-Nov-14 9-Sep-14 MS01 - Project Completion MS02-Completion of Structure MS03 - Producing Wild Air (till 30th Floor) MS04 - Producing Wild Air (31- 62th Floor) MS05 - Producing Wild Air (above 62th Floor) MS06 - Completion of P5 Slab at Zone B MS07 - Completion of Block Work till Level 36th MS08 - Completion of Façade Works (level 6 till level 10) TCP - Rev 3 Current Float -5 -51 Variance since Aug 14 Variance since Aug 14 08.Okt.14 > 5 days 0 to 5 days < 0 days 28.Okt.14 03.Nov.14 09.Nov.14 13.Nov.14 19.Nov.14 -55 -14 -37 12.Okt.14 -16 14-May-16 MS09 - Completion of Lift Works MS10 - Commencement of Swimming Pool Works Note: 1) Total Variance: the difference between TCP and Current Forecast. Slab L40 - Completion 21.Okt.14 Total Variance 16.Okt.14
  • 19.
    18 60- Dayslook Ahead Critical Activities TCP - Rev 3 Monthly Progress Report No. 7 - September 2014 25.Nov.14 30.Nov.14 20-Nov-14 -5 - 6.00 25.Nov.14 -5 - 6.00 30.Nov.14 -6 - 6.00 01.Okt.14 -7 - 9.00 08.Okt.14 -5 - 6.00 13.Okt.14 -5 - 6.00 19.Okt.14 -4 - 8.00 23.Okt.14 -6 - 9.00 29.Okt.14 -5 - 7.00 03.Nov.14 -5 - 6.00 09.Nov.14 -4 - 8.00 15.Nov.14 -4 - 9.00 19.Nov.14 -5 - 8.00 24.Nov.14 -5 - 7.00 29.Nov.14 -5 - 8.00 Activity Slab L46 - Completion Slab L47 - Completion Slab L48 - Completion Core Wall L39 - Completion Core Wall L40 - Completion Core Wall L41 - Completion Core Wall L42 - Completion Core Wall L43 - Completion Core Wall L46 - Completion Core Wall L47 - Completion Core Wall L48 - Completion Core Wall L49 - Completion 06.Dez.14 08.Okt.14 13.Okt.14 18.Okt.14 23.Okt.14 13.Nov.14 19.Nov.14 Core Wall L50 - Completion 04.Dez.14 3-Oct-14 Block Work Completion-L18 05.Aug.14 -59 - 3 0.00 Block Work Completion-L27 28.Sep.14 5-Oct-14 -7 - 7.00 Block Work Completion-L28 07.Okt.14 10-Oct-14 -3 - 6.00 Block Work Completion-L29 14.Okt.14 17-Oct-14 -3 - 7.00 Block Work Completion-L30 26.Okt.14 29-Oct-14 -3 - 1 3.00 Block Work Completion-L31 26.Okt.14 29-Oct-14 -3 - 7.00 Block Work Completion-L32 30.Okt.14 2-Nov-14 -3 - 5.00 Block Work Completion-L33 04.Nov.14 9-Nov-14 -5 - 6.00 Block Work Completion-L34 11.Nov.14 16-Nov-14 -5 - 7.00 Block Work Completion-L35 18.Nov.14 23-Nov-14 -5 - 8.00 Block Work Completion-L36 24.Nov.14 29-Nov-14 -5 - 8.00 Plaster Work Completion-L20 06.Sep.14 2-Oct-14 -26 - 6.00 Plaster Work Completion-L21 11.Sep.14 9-Oct-14 -28 - 7.00 Plaster Work Completion-L22 17.Sep.14 16-Oct-14 -29 - 8.00 Plaster Work Completion-L23 22.Sep.14 24-Oct-14 -32 - 1 0.00 Plaster Work Completion-L24 28.Sep.14 -26 - 4.00 Plaster Work Completion-L25 06.Okt.14 -25 - 5.00 Plaster Work Completion-L26 13.Okt.14 -19 - 2.00 Plaster Work Completion-L27 21.Okt.14 -16 - 1.00 Plaster Work Completion-L28 29.Okt.14 11-Nov-14 -13 - 1.00 Plaster Work Completion-L29 05.Nov.14 16-Nov-14 -11 - 4.00 Plaster Work Completion-L30 16.Nov.14 22-Nov-14 -6 - 2.00 Total Variance Current Forecast 29.Okt.14 Core Wall L44 - Completion 03.Nov.14 Core Wall L45 - Completion 08.Nov.14 Variance since Aug 14 24.Nov.14 29.Nov.14 24-Oct-14 31-Oct-14 1-Nov-14 6-Nov-14
  • 20.
    19 60- Dayslook Ahead Critical Activities TCP - Rev 3 Monthly Progress Report No. 7 - September 2014 Current Forecast 30-Nov-14 Plaster Work Completion-L31 16.Nov.14 -14 - 5.00 Paint Work Completion-L6 12.Jul.14 -82 - 2 6.00 Paint Work Completion-L7 19.Jul.14 2-Oct-14 -75 - 2 0.00 Paint Work Completion-L8 23.Jul.14 2-Oct-14 -71 - 1 5.00 Paint Work Completion-L9 30.Jul.14 3-Oct-14 -65 - 1 6.00 Paint Work Completion-L10 04.Aug.14 6-Oct-14 -63 - 1 7.00 Paint Work Completion-L11 09.Aug.14 -61 - 1 7.00 Paint Work Completion-L12 13.Aug.14 -61 - 1 7.00 Paint Work Completion-L13 18.Aug.14 -60 - 1 7.00 Paint Work Completion-L14 23.Aug.14 -59 - 1 9.00 Paint Work Completion-L15 27.Aug.14 -61 - 1 9.00 Paint Work Completion-L16 01.Sep.14 -62 - 1 9.00 Paint Work Completion-L17 08.Sep.14 -61 - 1 9.00 Paint Work Completion-L18 15.Sep.14 -60 - 1 9.00 Paint Work Completion-L19 21.Sep.14 21-Nov-14 -61 - 2 0.00 Paint Work Completion-L20 25.Sep.14 27-Nov-14 -63 - 2 0.00 Paint Work Completion-L21 01.Okt.14 6-Dec-14 -66 - 2 3.00 MEP H/L Completion - L29 07.Okt.14 11.Okt.14 -4 8.00 MEP H/L Completion - L30 11.Okt.14 23.Okt.14 -12 1.00 MEP H/L Completion - L31 14.Okt.14 20.Okt.14 -6 7.00 MEP H/L Completion - L32 20.Okt.14 27.Okt.14 -7 6.00 MEP H/L Completion - L33 28.Okt.14 03.Nov.14 -6 6.00 MEP H/L Completion - L34 04.Nov.14 10.Nov.14 -6 6.00 MEP H/L Completion - L35 11.Nov.14 17.Nov.14 -6 6.00 MEP H/L Completion - L36 17.Nov.14 23.Nov.14 -6 6.00 MEP H/L Completion - L37 23.Nov.14 29.Nov.14 -6 7.00 90% 34% 5% Variance since Aug 14 Activity 2-Oct-14 9-Oct-14 13-Oct-14 17-Oct-14 21-Oct-14 27-Oct-14 2-Nov-14 8-Nov-14 14-Nov-14 Total Variance Upward Trend Downward Trend No Change > 5 days 0 to 5 days < 0 days
  • 21.
    20 Physical %Complete 30 25 20 15 10 5 * Note: Physical % Complete based on TCP - Rev 3. Nomination of PS Items Clause 14 Program TCP - Rev 3 Current Float Var. since Aug 14 7-May-15 10-Aug-13 7-May-15 51 - 1-Oct-14 2-Feb-12 24-Feb-14 -178 - 30.00 1-Oct-14 3-Jun-12 20-Aug-14 69 - 30.00 21-Nov-12 20-Nov-14 15-Jan-13 18-Apr-13 Nominated 4-Mar-13 4-Nov-14 116 - 13-Nov-14 20 - 17-Apr-13 3-Sep-14 171 - 90% 34% 5% SC Nomination for Fit Out (Life Style) SC Nomination for Fit Out (Fendi Flat) SC Nomination for Sauna,Jacuzzi Critical Path (TCP-Rev 3) Work Packages 2013 2014 2015 2016 Planned Actual Impact on MS02 0.89 Schedule Performance Index (SPI) SC Nomination for Fit Out (Entrance) SC Nomination for Façade Lighting SC Nomination for Swimming Pool No Change Milestone Nominated Downward Trend > 5 days 0 to 5 days Monthly Progress Report No. 7 - September 2014 Progress % Complete Days Remaining until MS02 4-Nov-14 Impact on MS01 Concrete Skeleton Fit Out after Wild Air Façade Glazing Lifts Testing/Commissioning Current Forecast < 0 days 13-Nov-14 1-Oct-14 Upward Trend SC Nomination for Landscaping Works SC Nomination for Roof Steel Works Snagging 9.09 9.62 10.57 11.53 12.48 15.29 18.4 22.35 25.15 7.4 9.62 10.21 10.81 11.4 13.62 16.04 18.95 22.46 0 Planned % Actual % - 182 - 4 22.5 226
  • 22.
    21 Negative FloatContour Dominant Causes for Project Delays -10 Monthly Progress Report No. 7 - September 2014 Critical Paths Analysis Paths Package Activities Path 3 (Curtain Wall) Path 1 Façade Light Nomination, Procurement, Engineering, Installation. Path 4 (MEP Long Lead Items (Mechanical)) -20 Path 1 (Façade Light) Path 2 ( Bus Bars and LV Panels) -40 -144 -182 * Note: The shown analysis was run based on TCP-Rev 03, however, this version isn't approved so the shown analysis is only a tentative one. Path 3 Curtain Wall Installation of 7 elements for external façade (unitized system, stick system, doors, balcony partitions, cladding, balustrade and louvers. Float - 182.00 - 51.00 Path 4 MEP Long Lead Items (Mechanical) CW pumps submission/approval, procurement/installation, producing wild air, fit out works by JC Maclean. - 50.00 Path 2 -144 days Path 1 -182 days Path 3 -51 days Path 4 -50 days -182 THIS MONTH DELAYS IDENTIFIED Path 2 Bus Bars and LV Panels Procurement/installation of Bus Bars and LV Panels. - 144.00 Analysis run on 30-September-14
  • 23.
    22 Risk Analysis Risk Analysis on Critical Paths Monthly Progress Report No. 7 - September 2014 • Risk: Delay of -182 days • Driver: Late of Nomination of Façade Light • Mitigation: • The Engineer is of the view that the facade light nomination will not affect the project completion date, as the light fixtures will be installed before the project completion, which means there is enough time for procurement and engineering. • However, it is recommended that the client to expedite the nomination to avoid any risk to coordinate procurement with other parties. • Risk: Delay of -144 days • Driver: Procurement of Bus Bars and LV Panels • Mitigation: • An instruction issued by DAMAC to ATC to proceed with procuring the Bus Bars and LV Panels. The LPO will be issued during the month of October 2014. • On the other hand DAMAC/AECOM are working to get the NOC from Emaar in order to seek the design NOC from DEWA. Analysis run on 30-September-14 • Risk: Delay of -51 days • Driver: Delay in Curtain Wall Installation • Mitigation: • The design of secondry steel structure was done by ALICO. • ATC to submit the fabrication drawings to the engineer for approval. • Unitized panels will be delivered to site by 21- Oct-14. • Risk: Delay of -50 days • Driver: Chilled Water Pumps • Mitigation: • On the basis that the chilled water pumps will contribute in producing wild air so that the delay in submission the material submittal affected the delivery date to site and thus affected the commencement of wild air operation. However, the pumps are approved and the purchase order will be issued during August 2014. • The Engineer is of the view that the wild air is a vague issue so that Arabtec has been instructed many time in the weekly progress meetings to plan the wild air operation to allow the fit out work start and submit a proposal for review, however, ATC stated that the term ''wild air'' is not in the contract. Path 1 Path 2 Path 3 Path 4 Path 1 Path2 Path3 Path 4 200 180 160 140 120 100 80 60 40 20 0 Paths 182 144 51 50 Delays Critical Paths
  • 24.
    23 Slabs PlannedPouring Actual Pouring Progress Variance 23rd floor 02.Jul.14 4-Jul-14 100% - 2 .00 24th floor 10.Jul.14 10-Jul-14 100% - 1 .00 25th floor 19.Jul.14 17-Jul-14 100% 1 .00 26th floor 26.Jul.14 23-Jul-14 100% - 1 .00 27th floor 03.Aug.14 1-Aug-14 100% 1 .00 28th floor 09.Aug.14 9-Aug-14 100% - 29th floor 16.Aug.14 14-Aug-14 100% - 30th floor 23.Aug.14 22-Aug-14 100% - 1 .00 31st floor 31.Aug.14 31-Aug-14 100% - 32nd floor 06.Sep.14 7-Sep-14 100% - 1 .00 33rd floor 11.Sep.14 12-Sep-14 100% - 34th floor 16.Sep.14 18-Sep-14 100% - 1 .00 35th floor 21.Sep.14 24-Sep-14 100% - 1 .00 36th floor 27.Sep.14 30-Sep-14 100% - 3 .00 Progress Photographs Structure Progress - Level 36 Zone B - Section DD; Seepage Area Monthly Progress Report No. 7 - September 2014 57.12% 5.69% 17.50% 9.42% 12.38% %Pld %Act 0.00% 0.00% 3.42% 56.34% 3.38% 16.04% 20.63% 2.10% 0.38% DAMAC Heights Tower
  • 25.
    24 Core WallsPlanned Pouring Actual Pouring Progress Variance 23rd floor 21.Jun.14 15-Jun-14 100% - 24th floor 30.Jun.14 19-Jun-14 100% 2 .00 25th floor 06.Jul.14 26-Jun-14 100% 2 .00 26th floor 13.Jul.14 3-Jul-14 100% - 1 .00 27th floor 20.Jul.14 14-Jul-14 100% - 1 .00 28th floor 27.Jul.14 21-Jul-14 100% - 1 .00 29th floor 04.Aug.14 27-Jul-14 100% 1 .00 30th floor 11.Aug.14 13-Aug-14 100% 2 .00 31st floor 18.Aug.14 17-Aug-14 100% 7 .00 32nd floor 23.Aug.14 24-Aug-14 100% - 1 .00 33rd floor 28.Aug.14 28-Aug-14 100% 6 .00 34th floor 03.Sep.14 3-Sep-14 100% - 3 .00 35th floor 08.Sep.14 14-Sep-14 100% - 2 .00 36th floor 16.Sep.14 17-Sep-14 100% - 6 .00 37th floor 22.Sep.14 25-Sep-14 100% - 3 .00 38th floor 27.Sep.14 29-Sep-14 100% - 1 .00 Progress Photographs Dry Area: False Ceiling Suspension System @ Level 6 Corridor: False Ceiling Boards @ Level 6 Monthly Progress Report No. 7 - September 2014 57.12% 5.69% 17.50% 9.42% 12.38% %Pld %Act 0.00% 0.00% 3.42% 56.34% 3.38% 16.04% 20.63% 2.10% 0.38% DAMAC Heights Tower
  • 26.
    25 HVAC HLWorks Planned Finish Actual Finish Progress Variance 24th floor 30.Aug.14 91% 25th floor 06.Sep.14 90% 26th floor 13.Sep.14 90% 27th floor 21.Sep.14 84% 28th floor 28.Sep.14 69% 29th floor 07.Okt.14 52% FF HL Works Planned Finish Actual Finish Progress Variance 24th floor 30.Aug.14 99% 25th floor 06.Sep.14 98% 26th floor 13.Sep.14 96% 27th floor 21.Sep.14 96% 28th floor 28.Sep.14 88% 29th floor 07.Okt.14 78% Progress Photographs Wet Area: Wall Tiles and Water Proofing @ Level 6 Painting (Primer & Putty) @ Level 13 Monthly Progress Report No. 7 - September 2014 57.12% 5.69% 17.50% 9.42% 12.38% %Pld %Act 0.00% 0.00% 3.42% 56.34% 3.38% 16.04% 20.63% 2.10% 0.38% DAMAC Heights Tower
  • 27.
    26 Progress PhotographsMonthly Progress Report No. 7 - September 2014 Plumbing HL Work Planned Finish Actual Finish Progress Variance 24th floor 30.Aug.14 95% 25th floor 06.Sep.14 95% 26th floor 13.Sep.14 95% 27th floor 21.Sep.14 95% 28th floor 28.Sep.14 95% 29th floor 07.Okt.14 49% Electrical HL Work Planned Finish Actual Finish Progress Variance 24th floor 30.Aug.14 94% 25th floor 06.Sep.14 80% 26th floor 13.Sep.14 94% 27th floor 21.Sep.14 90% 28th floor 28.Sep.14 90% 29th floor 07.Okt.14 84% MEP High Level Service @ Level 27 Foundation for Equipment @ Level 30 57.12% 5.69% 17.50% 9.42% 12.38% %Pld %Act 0.00% 0.00% 3.42% 56.34% 3.38% 16.04% 20.63% 2.10% 0.38% DAMAC Heights Tower
  • 28.
    27 Monthly ProgressReport No. 7 - September 2014 Progress Photographs Blocks Planned Finish Actual Finish Progress Variance 17th floor 27-Jul-14 95% 18th floor 5-Aug-14 50% 19th floor 10-Aug-14 95% 20th floor 16-Aug-14 95% 21st floor 20-Aug-14 95% 22nd floor 27-Aug-14 95% 23rd floor 1-Sep-14 95% 24th floor 7-Sep-14 95% 25th floor 13-Sep-14 95% 26th floor 20-Sep-14 95% 27th floor 28-Sep-14 70% 28th floor 7-Oct-14 15% 29th floor 14-Oct-14 5% Substation - Trenches and Block Wall Stick Curtain Wall - Aluminium Cladding 57.12% 5.69% 17.50% 9.42% 12.38% %Pld %Act 0.00% 0.00% 3.42% 56.34% 3.38% 16.04% 20.63% 2.10% 0.38% DAMAC Heights Tower
  • 29.
    28 Concealed MEPPlanned Finish Actual Finish Progress Variance 19th floor 21-Aug-14 98% 20th floor 27-Aug-14 99% 21st floor 02.Sep.14 96% 22nd floor 08.Sep.14 96% 23rd floor 13.Sep.14 90% 24th floor 18.Sep.14 59% Plaster Planned Finish Actual Finish Progress Variance 17th floor 19-Aug-14 95% 18th floor 26-Aug-14 2% 19th floor 1-Sep-14 95% 20th floor 6-Sep-14 70% 21st floor 11-Sep-14 13% 22nd floor 17-Sep-14 5% Progress Photographs Stick Curtain Wall - Galss Panels Brackets Installation for Balcony Balustrade Monthly Progress Report No. 7 - September 2014 57.12% 5.69% 17.50% 9.42% 12.38% %Pld %Act 0.00% 0.00% 3.42% 56.34% 3.38% 16.04% 20.63% 2.10% 0.38% DAMAC Heights Tower
  • 30.
    29 Health, Safety& Environment HSE Statistics Total Hours Worked Work Force (Average) Monthly Progress Report No. 7 - September 2014 Fatalities Lost Time Injury First Aid Cases Near Misses 381,010 1465 0 0 2 3 4,292,339 1402 0 4 182 15 4,673,349 0 0 4 184 18 * Note: HSE Site Inspections Site Observations Notices (Improvement & Stop Works) Issues Closed Open Issued Closed Open Safety Audits (Average) 5 - 14 10 4 2 1 2 128 - 174 172 2 22 21 1 133 - 188 182 6 24 22 2 HSE Training & Seminars Orientation for New Hires 308 4,440 4,748 Significant Incidents 1 2 3 4 5 6 Critical Manageable Severe Negligible This Month 19 No. of Training Tool Box Talks Safety Training Safety Meetings Description/Comments Risk Rate Joint Inspections Recordable Injuries 0 19 Previous Months Total Project This Month Previous Months Total Project 4 66 70 Current Month Previous Months Total Project 195 1346 1541 5 60 65 Water seepage in section DD and a subsequent soil settlement along section BB and DD. C S M N C
  • 31.
    30 May Statistics 0 (0) 0 (4) 0 (19) 2 (184) 14 (188) LTI & Lost Work Days Monthly Progress Report No. 7 - September 2014 Fatalities LTI Total Hours Worked this Month Total Hours Worked Previous Months Total Hours Worked For the Project Work Force Average Notices Issued this Month Current Month (Cumulative Contract) Recordable Injuries First Aid Cases Site Observations Eye Injuries 0 (22) Back Injuries 0 (4) Face Injuries 0 (9) Trunk Front Injuries 0 (4) Hand Injuries 1 (62) Head Injuries 0 (4) Arm Injuries 1 (28) Leg Injuries 1 (35) Ankle/Foot Injuries 0 (14) 3.5 3 2.5 2 1.5 1 0.5 0 Lost Time Injury (LTI) Lost Work Days (LWD) 381,010 4,292,339 4,673,349 1465 2
  • 32.
    31 Engineering NOCsStatus Summary Actual Issue Date 17.Sep.13 GSM NOC RME/AECOM 19.Jun.14 - 23.Jän.11 14.Nov.13 25.Nov.13 10.Jul.14 09.Jun.13 27.Mai.14 06.Jul.14 05.Mai.13 25-Mar-13 27-Dec-11 25-Jun-12 9-Sep-13 90% # 34% 30 to < 60 days 5% RME > 60 days < 30 days Note: Days remaining from 30 Sep 2014 to Anticipated Date Expiry Date Days Remaining Responsible Dubai Civil Aviation 26.Mai.15 RME/AECOM RME/AECOM DEWA - Electrical Electrical Load Design NOC 04.Mai.15 RME/AECOM LV Design Drawing Approval Revised Approval is required RME/AECOM Substation / Trench Design Approval Revised Approval is required RME/AECOM Authority Etisalat Design NOC & Drawings Approval Monthly Progress Report No. 7 - September 2014 NOC/Permit Anticipated Issue Date Height NOC Warning Light NOC Revised Approval is required Final NOC after final design approval. Water Supply Design Drawing Approval Revised Approval is required RME/AECOM Revised Approval is required Revised Approval is required 16.Sep.15 RME/AECOM Etisalat RME ATC RME/AECOM RME/AECOM Revised Approval is required Dubai Municipality Fence NOC 22.Jul.11 Ground water Discharge 08.Mai.14 Drainage Design NOC and Drawings Approval FIC Location Approval Dubai Civil Defense Design Drawing Approval RME/AECOM DEWA - Water Water Design NOC 24-Mar-15 RME/AECOM EMAAR Water Seepage Remedial Works RME Dewatering Conditional NOC 24-Dec-12 RME Drainage NOC 9-Dec-13
  • 33.
    32 Critical AuthoritiesIssues Authority Action Subject NOCs & Dwgs. NOC DEWA, DM and Civil Defence Revised approvals are required due to the architectural changes. Engineering Submittal Status Report Planned Date Current Forecast 1 2 3 4 5 6 17 3 12 - 1 0 1 1266 58 1055 6 73 66 8 72 37 28 1 5 1 0 209 39 128 0 17 22 3 3- Revise& Resubmit 5- Under Review 4- Rejected 6- Review not required * Note: Only 2014 submittals have been considered. Submitted Open Closed 367 35 332 209 39 170 72 7 65 90% 81% 90% 19 89% 1266 145 1121 17 1 16 1931 227 1704 Monthly Progress Report No. 7 - September 2014 EMAAR 30.Okt.14 1- Approved 2- Approved as Noted Request for Information Materials Method Statement Prequalification Approval * Note: Only 2014 submittals have been considered. 94% 0 5 0 Review Category Submittals Closed % RFIs Closed Document Submittal Prequalification Approval NOC has to be given by Emaar in order to seek the design NOC from DEWA. Submitted 0 Total 88% Number of Submittals Submittals Open Shop Drawings Method Statements Materials Document Submittal Overdue % Closed Shop Drawings 88% 12% Submittals Closed Submittals Open 1931 1704 227 90%
  • 34.
    33 Quality Assurance& Control Non-Conformance Reports (NCR) Category 1: Per Work Package Monthly Progress Report No. 7 - September 2014 September NCRs Total NCRs Issued Closed Open Issued Close d Open Issued Closed Open 8 7 1 0 0 0 8 7 1 68 57 11 3 6 2 71 63 8 3 2 1 1 1 1 4 3 1 11 11 0 4 1 3 15 12 3 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 90 77 13 8 8 6 98 85 13 General Architectural MEP Lifts Category 2: Per Root Causes September NCRs Total NCRs Issued Closed Open Issued Close d Open Issued Closed Open 5,16,44,45,56,62, 64,73,86. 9 8 1 0 1 0 9 9 0 6,8,11,12,14,15,21,22,2 3,24,26,27,29, 32,38,39,43,51,53,54,8 0,81,98. 22 22 0 1 1 0 23 23 0 9,28,99,102,104. 2 1 1 3 0 3 5 1 4 34,49,50,66. 4 4 0 0 0 0 4 4 0 1,37,40,69,82. 5 5 0 0 0 0 5 5 0 10,13,17,18,19,20,25,3 0,31,33,35,41,46,47,48, 52,55,57,58,59,60,65,6 8,70,71,72,74,75,76,77, 78,79,83,84,85,88,89,9 0,91,94,96,100,101. 40 30 10 3 5 3 43 35 8 2,3,7,42,61,63,67,87,95 . 8 7 1 1 1 0 9 8 1 90 77 13 8 8 6 98 85 13 Use of Unapproved Drawings/Materials Deviation from Specifications Not Following Manufacturer's Instructions Deviation from the Safety Requirements Not working as per Method Statement Bad Workmanship Others Total Use of Unapproved Drawings/Material Total Work Area Previous NCRs Others NCR ID Deviation from Specifications Not Following Manufacturer's Instructions Deviation from the Safety Requirements Not working as per Method Statement Bad Workmanship Previous NCRs Work Area Structural External Façade 9 23 5 4 5 43 9 A B C D E F G
  • 35.
    34 Key QualityImprovement Measures Implemented in the Month • CurreŶtlLJ ATC keeps suďŵittiŶg the ĐoŶĐrete test results iŶ tiŵelLJ ŵaŶŶer as was instructed by AECOM. • AECOM iŶstruĐted ATC to suďŵit the struĐtural ĐlearaŶĐe ďefore the commencement of MEP work. • AECOM is going to hold Quality Technical Meetings on weekly basis to monitor the quality. Audits Internal External Quality Trending Monthly Progress Report No. 7 - September 2014 NCR Closed % NCR Opened % Total NCRs Raised NCRs Closed NCRs Opened 8 NON-CONFORMANCE IDENTIFIED THIS MONTH Quality Improvement Measures 3 9 4 6 3 3 13 9 6 5 13 8 14 12 10 8 6 4 2 0 NCR Raised 87% 13% 98 85 13
  • 36.
    35 Commercial Status Cost Summary (AED) Monthly Progress Report No. 7 - September 2014 244,747,598 8,177,509 - 226,116,726 479,041,833 37,437,524 1,899,214 20,000,000 7,738,272 - - 27,738,272 - 297,020 389,706 686,726 515,808 GHU 1,676,655 1,595,000 81,655 - - 1,676,655 - - Payment Status (AED) AED % AED % AED % AED 119,845,391 23.58% 115,383,973 22.7% 75,444,872 14.8% 63,693,496 21,989,206 79.3% 21,989,206 79.3% 21,436,431 77.3% 21,792,331 686,726 100.0% 618,053 90.0% 418,956 61.0% 618,053 1,403,119 83.7% 1,262,807 75.3% 1,355,221 80.8% 1,320,372 516479357.2 27738271.57 686726.1 * Note: The percentage value is the current amount divided by the Contract Price ATC IPC# 39 (Aug-14) was considered for this report. ATC RMB IGS GHU Variation Status 1676655 Variation Approved Cumulative Current Month Variation Rejected Variation DAMAC Assessment Variation ATC Assessment Variation Approved Variation Rejected Variation DAMAC Assessment 35 9 9 26 0 0 0 Variation Value (AED) Variation Approved Variation Rejected Variation DAMAC Assessment Variation ATC Assessment Variation Approved Variation Rejected Variation DAMAC Assessment 8,177,509 6,801,791 1,679,024 220,190 Key Commercial Issues 1 2 Monthly Progress Report No. 7 - September 2014 36 All Gross/Net Certified and Paid to Date Values excluded Advance Payments. Item Management Strategy Extension of Time Claims EOT flooding claims are under review by 3rd party, anticipated closure in October 2014. ATC's Pending Variations Variations submission, assessment and approval continues. Variation ATC Assessment ATC 0 Cumulative Current Month Variation ATC Assessment ATC 12.53% 78.56% 95.29% 81.63% Effective Contract Value Approved Variations Approved Claims Approved PS Total Commitments Residual PS Pending Variations Estimate at Completion ATC 518,378,571 RMB 27,738,272 IGS 1,202,534 Paid to Date % Gross Certified Net Certified Previously Certified
  • 37.
    Cash Flow (AED,000) 1,300 1,200 1,100 1,000 900 800 700 600 500 400 300 200 100 Notice of Delays Under Review Ref . Date Received Delayed nomination of Elevators Delayed nomination of MEP Delayed nomination of Glazing 1 19-Feb-12 2 19-Feb-12 3 19-Feb-12 4 Delayed nomination of BMU 19-Feb-12 5 Delayed nomination of Façade Light 19-Feb-12 6 Delayed nomination of Sanitary Fittings 19-Feb-12 7 Delayed nomination of Home Automation 19-Feb-12 8 19-Feb-12 9 19-Feb-12 10 19-Feb-12 11 2-Apr-12 12 2-Apr-12 13 6-May-13 14 6-May-13 15 6-May-13 16 6-May-13 17 6-May-13 18 6-May-13 19 6-May-13 20 6-May-13 21 18-Aug-13 22 12-Feb-14 23 5-Mar-14 23.58 12.53 Delayed nomination of Kitchen Cabinet Delayed nomination of Shower Enclosure ATC Total Variations Delayed nomination of Timber Doors/Ironmongery Approved Delayed nomination of Vanity Counter Delayed nomination of Swimming Pool Delayed nomination of Toilet Access. Delayed nomination of Light Fittings Delayed nomination of Roof Features Equipment Delayed nomination of Fit out for Entrance * Note: Only SC's nominations delays have mentioned. Ref . 35 ATC Total Variations Rejected Delayed nomination of Wardrobe, Vanaties Delayed nomination of Mirrors Delayed nomination of Landscape Delayed nomination of Fit out for HC Delayed nomination of Supply Porcelain/Ceramic Tiles Item Date Received No Claims closed to date - ATC Total Variations Delayed nomination of Fit out for Saunna,Steam and Pending Delayed nomination of Fit out for Signage/Lockers Claims Closed ATC Gross % Certified * Note: Cash flow will be produced after agreeing the target completion program. Item ATC Paid % to Date 35 9 0 Monthly Planned Monthly Actual Cum. Planned Cum. Actual
  • 38.
    37 Risk Management Top 7 Risks RS_04 Risk Event Cause Risk Response Delays in possessing DEWA approval for LV shop drawings and delays in procuring LV Panels and Bus Bars Re-design of secondary steel structure to support the façade Changes to the mechanical floors arrangement and absence of the design for P5. Monthly Progress Report No. 7 - September 2014 ALICO designed the secondary steel structure. ATC to expidite submission of fabrication drawings for approval in order to place the material order. DAMAC/R ME ATC Risk ID Rating Risk Owner DAMAC/ AECOM RS_01 RS_02 Late of issuing MEP IFC drawings. RME to issue the final MEP IFC drawings. Also the renewal of DEWA design NOC to be done. On the other hand an instruction to proceed with procurment was issued by DAMAC. Flooding in Zone B Seepage through openings in the existing diaphragm walls. Seepage occurred during September 2014 and AECOM will provide a proposal for a permanent soluation to the diaphragm wall. ATC/ REMCO RS_03 Delays in pouring the slab of level 62 8 days estimated cycle will not be achieved as the core wall will need for 2 weeks at least. AECOM highlighted this issue to ATC in the weekly progress meeting, however, no mitigation provided. ATC RS_05 Delays In MEP high level installations, Concealed Work and Risers Work Delays from REMCO in high level works installation due to insufficient of manpower. REMCO to increase the allocated manpower in order to work concurrently in 5 levels. RS_07 BMU Functionality DAMAC ALICO RS_06 Delays in nomination of the PS items DAMAC's tenders floating/awarding process delayed. DAMAC has to expedite the PS items' procuring process in order to avoid delaying the site works. Notably façade light package. There is no coordination between the BMU and Façade Designs. Alico is doing the technical study. Risk Rating Breakdown 5 4 3 2 1 0 Critical Severe Manageable Negligible Critical Severe Manageable Negligible
  • 39.
    38 Core Values into Practice R Monthly Progress Report No. 7 - September 2014
  • 40.
    39 AECOM CoreValues 'To enhance and sustain the world’s built, natural and social environments'' Monthly Progress Report No. 7 - September 2014 Growth We recognize that our financial growth is the fairly earned result of living up to these principles. We earn and advance our reputation by delivering superior value on every project that we undertake. Our industry leadership depends on making project solutions more exciting, sustainable and cost-effective. We move with speed and dexterity to adapt and adjust to emerging client and project requirements. 9 Core Values We succeed by doing things the right way, with respect to ethics, laws, standards of quality, and each other. Employees Our product is our people — our knowledge, skills, passion and diversity. Our success begins with valuing our people and fostering their development. We succeed by making our clients successful. We embrace our clients’ challenges and opportunities and work for their success. Whether in an office or on a construction site, keeping our people safe is our most important measure of success. Clients Excellence Innovation Safety Integrity Agility File :- Printed On :- 16.10.2014 at 10:38
  • 41.
    40 Core Valuesinto Practice AECOM Solutions Time Cost 1 AECOM advice to allow the building tower to proceed beyond Level 15 in absence of Zone B Raft being completed. 15 weeks + delays EOT Costs High AECOM reviewed the Structure and concluded that there was no impact on the design to allow the tower structure to proceed without Zone B. CS-Site based Structural B+P-Structural Implemented by AECOM and closed impact negated. No: It is Design Related. Design decision required from Ramboll- however design consultant did not provide an adequate response. INT, CLN, EX, AG, SA 2 Soil Improvement outside the plot to stabilize extent monitoring and supervision and the need to decide when to commence excavation. Continued delay to Zone B construction added to the current claim by ATC for flood event including suspension of all work. EOT Costs+ Damages + Insurance claims+suspension of work costs. High AECOM reviewed the Client proposed solution and methodology and devised an implementation plan in coordination with AECOM Geotechnical department to minimize the risk on the area and provided an implementation plan with monitoring and contingency measures to allow for commencement of excavation work. CS-Site based Civil/ Structural TRN-Geotechnical Implemented by AECOM ongoing No: AECOM Scope covers supervision services and monitoring only. AECOM provided advice and recommendations to the implementation of the solution proposed by the client without any liability for the success or failure of the solution proposed. INT, CLN, EX, AG, SA AECOM Values Legend Monthly Progress Report No. 7 - September 2014 Sr. Description Impacted if not addressed Risk AECOM Solution AECOM Discipline involved Status Included in Scope AECOM Values INT: Integrity CLN: Client GR: Growth EX: Excellence INN: Innovation AG: Agility EMP: Employees SA: Safety 9 Core Values File :- Printed On :- 16.10.2014 at 10:38
  • 42.
    41 Core Valuesinto Practice AECOM Solutions Time Cost 3 Sub Contractor for Post-tensioned slab design highlighting punching shear overstress in various columns from levels 26 and above. Delay to the casting of the slabs. Increased cost of adding reinforcement and concrete as drop caps and shear reinforcement at the identified columns. Medium AECOM site structural team reviewed the calculations and advised that the sub contractor was not applying the loads correctly thereby eliminating the added measures. CS-Site Structural Implemented by AECOM and closed negating the impact Monthly Progress Report No. 7 - September 2014 No: It is Design Related. Design decision required from Ramboll- however design consultant did not provide adequate response, AECOM provided the guidance through on site workshop and obtained Design Consultant, 3rd party and Employer consensus resulting in the sub contractor revising his comments. INT, CLN, EX, AG, SA 4 AECOM Values Legend Included in Scope AECOM Values INT: Integrity CLN: Client GR: Growth EX: Excellence INN: Innovation AG: Agility EMP: Employees SA: Safety 9 Core Values Sr. Description Impacted if not addressed Risk AECOM Solution AECOM Discipline involved Status File :- Printed On :- 16.10.2014 at 10:38
  • 43.
    42 Appendices R Monthly Progress Report No. 7 - September 2014
  • 44.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 1 Schedule Update
  • 45.
    Activity ID ActivityName Original Duration DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 Total 2012.00 24-Feb-14 14-May-16 05-Jun-11 A 20-Dec-16 -220.00 25.15% 22.46% 0.89 DAMAC HEIGHTS-Target Completion Programme- Rev 3.1 2012.00 24-Feb-14 14-May-16 05-Jun-11 A 20-Dec-16 -220.00 25.15% 22.46% 0.89 GENERAL 2012.00 24-Feb-14 14-May-16 05-Jun-11 A 20-Dec-16 -220.00 100% 0% 0.00 KEY DATES 1700.00 15-Nov-14 14-May-16 05-Jun-11 A 20-Dec-16 -182.00 0% 0% 0.00 DHKMSGN220 IFC Drawing 0.00 05-Jun-11 A 100% 100% 0.00 DHKMSGN200 Commencement Date 0.00 19-Jun-11 A 100% 100% 0.00 DHKMSGN210 Site Possession 0.00 19-Jun-11 A 100% 100% 0.00 DHKMSGN250 DM Approval on enabling Work Completion 0.00 02-Oct-12 A 100% 100% 0.00 DHKMSGN260 Approval test results on Enabling Work items 0.00 02-Oct-12 A 100% 100% 0.00 DHKMSGN240 Dewatering System Handing Over 0.00 22-Oct-12 A 100% 100% 0.00 DHKMSGN230 Building Permit 0.00 27-Mar-13 A 100% 100% 0.00 DHKMSGN470 Design Nocs 0.00 18-Apr-13 A 100% 100% 0.00 DHKMSGN410 Tower Raft Pour 0.00 17-May-13 A 100% 100% 0.00 DHKMSGN420 Overall Foundation Completion 0.00 15-Nov-14 21-Dec-14 -28.00 0% 0% 0.00 DHKMSGN430 Basement/Podium Completion of Structure up to GF 0.00 19-Feb-15 26-Mar-15 -28.00 0% 0% 0.00 DHKMSGN400 Partial Power On (Up to Lvl.30) 0.00 19-Feb-15 19-Apr-15 -50.00 0% 0% 0.00 DHKMSGN500 Wild Air On (Up to Lvl..29) 0.00 08-Mar-15 05-May-15 -50.00 0% 0% 0.00 DHKMSGN450 Podium Completion of Structure up to Lv. P5 0.00 04-Jun-15 09-Jul-15 -1.00 0% 0% 0.00 DHKMSGN402 Partial Power On (Lvl.31-61) 0.00 14-Jun-15 20-Jul-15 -14.00 0% 0% 0.00 DHKMSGN502 Wild Air On (Lvl.31-61) 0.00 21-Jul-15 06-Aug-15 -14.00 0% 0% 0.00 DHKMSGN452 Completion of Structure 0.00 12-Aug-15 17-Aug-15 7.00 0% 0% 0.00 DHKMSGN440 Completion of Facade Cladding Up to Lvl.85 0.00 15-Aug-15 18-Oct-15 -10.00 0% 0% 0.00 DHKMSGN462 Wild Air On (Level 62 above) 0.00 08-Nov-15 02-Jan-16 -46.00 0% 0% 0.00 DHKMSGN442 Completion of Facade Cladding Up to top 0.00 12-Nov-15 13-Jan-16 -5.00 0% 0% 0.00 DHKMSGN460 Permanent Power On (Overall) 0.00 08-Dec-15 25-May-16 -144.00 0% 0% 0.00 DHKMSGN990 Project Completion 0.00 14-May-16 20-Dec-16 -182.00 0% 0% 0.00 EMPLOYER KEY DATES 1756.00 07-Sep-14 19-Feb-16 15-Oct-12 A 30-Jun-16 -77.00 0% 0% 0.00 ISSUANCE OF VALID NOCs (BY OTHERS) 0.00 24-Feb-14 16-Mar-14 30-Sep-14 30-Sep-14 25.00 0% 0% 0.00 AUTHORITIES APPROVALS 1069.00 24-Feb-14 08-Mar-16 05-May-13 A 25-May-16 -63.00 100% 0% 0.00 DEWA POWER ON 1069.00 24-Feb-14 08-Mar-16 05-May-13 A 25-May-16 -63.00 100% 0% 0.00 SUB-STATION WORKS 1069.00 16-Mar-14 08-Dec-15 05-May-13 A 25-May-16 -169.00 100% 0% 0.00 LOAD SCHEDULE 100.00 18-Mar-14 24-Jul-14 18-Mar-14 A 19-Jan-15 -175.00 0% 0% 0.00 DHDWALS010 Prepare Shop Drawings 10.00 18-Mar-14 29-Mar-14 18-Mar-14 A 02-Oct-14 -145.00 100% 99% 0.00 DHDWALS020 Prepare Load Schedules 10.00 26-Mar-14 06-Apr-14 05-Apr-14 A 13-Oct-14 -145.00 100% 99% 0.00 DHDWALS090 Engineer's Review 14.00 07-Apr-14 20-Apr-14 20-May-14 A 14-Oct-14 -175.00 100% 99% 0.00 DHDWALS030 Submit Load Schedules to DEWA REV 00 5.00 20-Apr-14 26-Apr-14 15-Oct-14 20-Oct-14 -145.00 100% 0% 0.00 DHDWALS040 DEWA : Return Load Schedules with comments REV00 21.00 27-Apr-14 25-May-14 21-Oct-14 18-Nov-14 -122.00 100% 0% 0.00 DHDWALS050 Resubmit Load Schedules REV 01 5.00 26-May-14 30-May-14 19-Nov-14 23-Nov-14 -174.00 100% 0% 0.00 DHDWALS060 DEWA : Return Load Schedules with comments REV01 21.00 31-May-14 20-Jun-14 24-Nov-14 14-Dec-14 -174.00 100% 0% 0.00 DHDWALS070 Resubmit Load Schedules REV 02 5.00 21-Jun-14 25-Jun-14 15-Dec-14 20-Dec-14 -143.00 100% 0% 0.00 DHDWALS080 DEWA: Approve Load Schd. REV02 & Issue Const. NOC 21.00 26-Jun-14 24-Jul-14 21-Dec-14 19-Jan-15 -121.00 100% 0% 0.00 SUB-STATION WORKS 667.00 16-Mar-14 02-Feb-15 05-May-13 A 20-Apr-15 -62.00 100% 0% 0.00 DHDWASS110 Prepare Substation Trench Layout Shop Drg 45.00 16-Mar-14 16-Mar-14 05-May-13 A 21-Jun-13 A 100% 100% 0.00 DHDWASS120 Submit SS Trench Layout Shop Drg to DEWA 4.00 16-Mar-14 16-Mar-14 22-Jun-13 A 27-Jun-13 A 100% 100% 0.00 DHDWASS130 DEWA: Return Substation Layout Drg With Comments 12.00 16-Mar-14 16-Mar-14 28-Jun-13 A 09-Jul-13 A 100% 100% 0.00 DHDWASS140 Incorporate DEWA Comments in Shop Drgs 12.00 16-Mar-14 16-Mar-14 10-Jul-13 A 22-Jul-13 A 100% 100% 0.00 DHDWASS150 Resubmit SS Trench Layout Shop Drg to DEWA 6.00 16-Mar-14 16-Mar-14 23-Jul-13 A 30-Jul-13 A 100% 100% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Overall Foundation Completion Basement/Podium Completion of Structure up to GF Partial Power On (Up to Lvl.30) Wild Air On (Up to Lvl..29) Podium Completion of Structure up to Lv. P5 Partial Power On (Lvl.31-61) Wild Air On (Lvl.31-61) Completion of Structure Completion of Facade Cladding Up Prepare Shop Drawings Prepare Load Schedules Engineer's Review Submit Load Schedules to DEWA REV 00 DEWA : Return Load Schedules with comments REV00 Resubmit Load Schedules REV 01 DEWA : Return Load Schedules with comments REV01 Resubmit Load Schedules REV 02 DEWA: Approve Load Schd. REV02 & Issue Const. NOC DEWA: Return Substation Layout Drg With Comments Resubmit SS Trench Layout Shop Drg to DEWA Data Date : 30-Sep-14 Page : 1 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 46.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHDWASS160 DEWA : Approve SS Trench Layout Shop Drawings 21.00 16-Mar-14 16-Mar-14 31-Jul-13 A 27-Aug-13 A 100% 100% 0.00 DHDWASS170 Complete Substations Trench Works 60.00 01-Jun-14 15-Jun-14 21-Sep-13 A 22-Jun-14 A 100% 100% 0.00 DHDWASS010 Access to Substation 0.00 16-Jun-14 02-Sep-14 A 100% 100% 0.00 DHDWASS020 Fix Cable Trays 6.00 05-Aug-14 11-Aug-14 22-Oct-14 29-Oct-14 -52.00 100% 0% 0.00 DHDWASS030 Fix Electrical Conduits 6.00 12-Aug-14 18-Aug-14 30-Oct-14 05-Nov-14 -52.00 100% 0% 0.00 DHDWASS040 Power & Lighting Wiring 6.00 19-Aug-14 25-Aug-14 06-Nov-14 12-Nov-14 -52.00 100% 0% 0.00 DHDWASS050 Install & Terminate DB's 6.00 26-Aug-14 01-Sep-14 13-Nov-14 19-Nov-14 -52.00 100% 0% 0.00 DHDWASS060 Install Wiring Devices 6.00 02-Sep-14 08-Sep-14 20-Nov-14 26-Nov-14 -52.00 100% 0% 0.00 DHDWASS070 Install Light Fittings 6.00 02-Sep-14 08-Sep-14 20-Nov-14 26-Nov-14 -48.00 100% 0% 0.00 DHDWASS080 Install Emergency Lights 6.00 02-Sep-14 08-Sep-14 20-Nov-14 26-Nov-14 -48.00 100% 0% 0.00 DHDWASS090 Install Fire Alarm 5.00 03-Sep-14 08-Sep-14 22-Nov-14 26-Nov-14 -48.00 100% 0% 0.00 DHDWASS100 Substation Works Completion 0.00 22-Sep-14 11-Dec-14 -52.00 100% 0% 0.00 DHDWASS180 Substation Ready for Inspection 0.00 22-Sep-14 11-Dec-14 -52.00 100% 0% 0.00 DHDWASS190 Consultant : Inspect Substation 3.00 23-Sep-14 25-Sep-14 13-Dec-14 15-Dec-14 -52.00 100% 0% 0.00 DHDWASS200 Consultant : Submit Inspection check list to DEWA 6.00 27-Sep-14 02-Oct-14 16-Dec-14 22-Dec-14 -52.00 66.67% 0% 0.00 DHDWASS210 DEWA : Inspect Substation 20.00 05-Oct-14 02-Nov-14 23-Dec-14 20-Jan-15 -44.00 0% 0% 0.00 DHDWASS220 Address DEWA Comments 20.00 03-Nov-14 25-Nov-14 21-Jan-15 12-Feb-15 -53.00 0% 0% 0.00 DHDWASS230 Consultant : Reinspect Substation 12.00 26-Nov-14 10-Dec-14 14-Feb-15 26-Feb-15 -53.00 0% 0% 0.00 DHDWASS240 Consultant : Resubmit Inspection request to DEWA 20.00 11-Dec-14 04-Jan-15 28-Feb-15 22-Mar-15 -53.00 0% 0% 0.00 DHDWASS250 DEWA : Reinspect & Approve Substation 20.00 05-Jan-15 01-Feb-15 23-Mar-15 19-Apr-15 -44.00 0% 0% 0.00 DHDWASS260 Substation Ready for HT Cable / Transformer Work 0.00 02-Feb-15 20-Apr-15 -53.00 0% 0% 0.00 LV ROOM WORKS 603.00 21-Oct-14 08-Dec-15 01-Oct-14 25-May-16 -169.00 0% 0% 0.00 DHDWALV000 Access to LV Room 0.00 21-Oct-14 01-Oct-14 131.00 0% 0% 0.00 DHDWALV010 Cable Ladder & Tray Fixing 26.00 21-Oct-14 20-Nov-14 01-Oct-14 03-Nov-14 131.00 0% 0% 0.00 DHDWALV020 Earthing Strips laying 20.00 05-Nov-14 27-Nov-14 18-Oct-14 10-Nov-14 139.00 0% 0% 0.00 DHDWALV030 Cable lying & Terminations 26.00 22-Nov-14 22-Dec-14 04-Nov-14 04-Dec-14 139.00 0% 0% 0.00 DHDWALV040 Panel Installation 45.00 03-Jan-15 23-Feb-15 08-Mar-15 28-Apr-15 61.00 0% 0% 0.00 DHDWALV050 Panel Earthing termination 15.00 24-Feb-15 12-Mar-15 29-Apr-15 17-May-15 61.00 0% 0% 0.00 DHDWALV060 Install MDB & Termination 30.00 19-Mar-15 22-Apr-15 22-Sep-15 29-Oct-15 -46.00 0% 0% 0.00 DHDWALV170 Install Chequered Plates 12.00 23-Apr-15 04-May-15 30-Oct-15 10-Nov-15 -43.00 0% 0% 0.00 DHDWALV070 Install Wiring Devices 12.00 23-Apr-15 06-May-15 31-Oct-15 12-Nov-15 -46.00 0% 0% 0.00 DHDWALV080 Install Light Fittings 12.00 07-May-15 21-May-15 14-Nov-15 26-Nov-15 -46.00 0% 0% 0.00 DHDWALV090 Install FM 200 System 12.00 23-May-15 04-Jun-15 28-Nov-15 12-Dec-15 -46.00 0% 0% 0.00 DHDWALV100 Install Fire Alarm Devices 12.00 06-Jun-15 18-Jun-15 13-Dec-15 26-Dec-15 -46.00 0% 0% 0.00 DHDWALV110 Complete All MEP Installation in Building 0.00 01-Nov-15 26-Dec-15 -46.00 0% 0% 0.00 DHDWALV120 Submit Inspection request to DEWA 12.00 02-Nov-15 15-Nov-15 27-Dec-15 09-Jan-16 -46.00 0% 0% 0.00 DHDWALV130 DEWA : Inspect Installation 3.00 16-Nov-15 18-Nov-15 10-Jan-16 12-Jan-16 -38.00 0% 0% 0.00 DHDWALV140 Address Comments of DEWA 6.00 19-Nov-15 25-Nov-15 08-May-16 14-May-16 -144.00 0% 0% 0.00 DHDWALV150 Resubmit Inspection Request to DEWA 3.00 26-Nov-15 29-Nov-15 15-May-16 17-May-16 -144.00 0% 0% 0.00 DHDWALV160 DEWA : Inspect & Approve Installations 6.00 30-Nov-15 08-Dec-15 18-May-16 25-May-16 -121.00 0% 0% 0.00 PERMANENT POWER APPLICATION 115.00 02-Feb-15 26-May-15 20-Apr-15 12-Aug-15 -63.00 0% 0% 0.00 DHDWAPA000 Application Registration 60.00 02-Feb-15 12-Apr-15 20-Apr-15 29-Jun-15 -53.00 0% 0% 0.00 DHDWAPA010 DEWA : Estimate amount for permit power 26.00 14-Apr-15 19-May-15 01-Jul-15 05-Aug-15 -45.00 0% 0% 0.00 DHDWAPA020 Client : Pay Estimate amount to DEWA 0.00 26-May-15 12-Aug-15 -45.00 0% 0% 0.00 HIGH TENSION WORKS 222.00 20-Jun-15 08-Dec-15 05-Sep-15 25-May-16 -144.00 0% 0% 0.00 DHDWAHT000 DEWA : HT Cable Work & Transformer Procurement & Installat1io3n0.00 20-Jun-15 23-Nov-15 05-Sep-15 07-Feb-16 -52.00 0% 0% 0.00 DHDWAHT010 Permanent Power on 0.00 08-Dec-15 25-May-16 -144.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec DEWA : Approve SS Trench Layout Shop Drawings Complete Substations Trench Works Access to Substation Fix Cable Trays Fix Electrical Conduits Power & Lighting Wiring Install & Terminate DB's Install Wiring Devices Install Light Fittings Install Emergency Lights Install Fire Alarm Substation Works Completion Substation Ready for Inspection Consultant : Inspect Substation Consultant : Submit Inspection check list to DEWA DEWA : Inspect Substation Address DEWA Comments Consultant : Reinspect Substation Consultant : Resubmit Inspection request to DEWA DEWA : Reinspect & Approve Substation Substation Ready for HT Cable / Transformer Work Access to LV Room Cable Ladder & Tray Fixing Earthing Strips laying Cable lying & Terminations Panel Installation Panel Earthing termination Install MDB & Termination Install Chequered Plates Install Wiring Devices Install Light Fittings Install FM 200 System Application Registration DEWA : Estimate amount for permit power Client : Pay Estimate amount to DEWA DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 2 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 47.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DEWA WATER 567.00 03-Mar-14 08-Mar-16 26-Jan-14 A 12-Apr-16 -20.00 0% 0% 0.00 DUBAI CIVIL DEFENCE 104.00 27-Feb-14 06-Jul-14 24-Feb-14 A 24-Feb-14 A 0% 0% 0.00 CIVIL AVIATION 223.00 29-Oct-14 04-Jun-15 24-Feb-14 A 24-Feb-14 A 0% 0% 0.00 ETISALAT/ DU 383.00 03-Mar-14 14-Jul-15 24-Feb-14 A 11-Oct-15 66.00 0% 0% 0.00 DM DRAINAGE 567.00 24-Feb-14 08-Mar-16 24-Feb-14 A 12-Apr-16 -20.00 0% 0% 0.00 CONSTRUCTION EQUIPMENTS 1570.00 24-Feb-14 14-Nov-15 11-May-13 A 13-Jan-16 -60.00 0% 0% 0.00 ENGINEERING & PROCUREMENT 1843.00 24-Feb-14 07-Dec-15 19-Jun-11 A 02-Feb-16 128.00 0% 0% 0.00 PROVISIONAL SUMS 658.00 24-Feb-14 01-Oct-15 13-Aug-13 A 01-Oct-15 132.00 0% 0% 0.00 MEP LONG LEAD ITEMS 319.00 19-Mar-14 22-Jul-15 14-Jan-14 A 05-Oct-15 -29.00 0% 0% 0.00 Electrical 307.00 10-Jun-14 05-Apr-15 05-Mar-14 A 05-Oct-15 -46.00 0% 0% 0.00 Bus Bar 127.00 10-Jul-14 14-Jan-15 05-Mar-14 A 17-Jun-15 -128.00 0% 0% 0.00 A3260 Material Submittal 14.00 10-Jul-14 26-Jul-14 05-Mar-14 A 16-Apr-14 A 100% 100% 0.00 A3270 Material Approval 14.00 27-Jul-14 13-Aug-14 06-Mar-14 A 06-May-14 A 100% 100% 0.00 A3280 Issue of PO to Supplier 7.00 14-Aug-14 21-Aug-14 20-Jan-15 27-Jan-15 -128.00 100% 0% 0.00 A3290 Manufacturing /Procurement and Delivery of the Material 120.00 23-Aug-14 14-Jan-15 28-Jan-15 17-Jun-15 -128.00 28.33% 0% 0.00 Wiring Accessories 227.00 28-Oct-14 05-Apr-15 16-Apr-14 A 08-Feb-15 52.00 0% 0% 0.00 A3220 Material Submittal 14.00 28-Oct-14 12-Nov-14 16-Apr-14 A 18-May-14 A 0% 100% 0.00 A3230 Material Approval 14.00 13-Nov-14 29-Nov-14 17-Apr-14 A 02-Jun-14 A 0% 100% 0.00 A3240 Issue of PO to Supplier 7.00 30-Nov-14 08-Dec-14 01-Oct-14 11-Oct-14 52.00 0% 0% 0.00 A3250 Manufacturing /Procurement and Delivery of the Material 100.00 09-Dec-14 05-Apr-15 12-Oct-14 08-Feb-15 52.00 0% 0% 0.00 LV Panels & Switchgear 127.00 10-Jun-14 14-Dec-14 18-Mar-14 A 03-Mar-15 104.00 0% 0% 0.00 A3300 Material Submittal 14.00 10-Jun-14 25-Jun-14 18-Mar-14 A 01-May-14 A 100% 100% 0.00 A3310 Material Approval 14.00 26-Jun-14 12-Jul-14 19-Mar-14 A 15-May-14 A 100% 100% 0.00 A3320 Issue of PO to Supplier 7.00 13-Jul-14 20-Jul-14 01-Oct-14 11-Oct-14 104.00 100% 0% 0.00 A3330 Manufacturing /Procurement and Delivery of the Material 120.00 21-Jul-14 14-Dec-14 12-Oct-14 03-Mar-15 104.00 50% 0% 0.00 Generator 193.00 15-Jul-14 30-Mar-15 24-Aug-14 A 05-Oct-15 -46.00 0% 0% 0.00 A3340 Material Submittal 14.00 15-Jul-14 02-Aug-14 24-Aug-14 A 19-Feb-15 -46.00 100% 78.57% 0.00 A3350 Material Approval 14.00 03-Aug-14 18-Aug-14 25-Aug-14 A 23-Feb-15 -46.00 100% 78.57% 0.00 A3360 Issue of PO to Supplier 7.00 19-Aug-14 26-Aug-14 24-Feb-15 03-Mar-15 -46.00 100% 0% 0.00 A3370 Manufacturing /Procurement and Delivery of the Material 180.00 27-Aug-14 30-Mar-15 04-Mar-15 05-Oct-15 -46.00 16.67% 0% 0.00 ELV 227.00 19-Mar-14 28-Apr-15 16-Feb-14 A 03-Mar-15 151.00 0% 0% 0.00 BMS 227.00 28-Oct-14 28-Apr-15 08-Jun-14 A 03-Mar-15 151.00 0% 0% 0.00 A3420 Material Submittal 14.00 28-Oct-14 12-Nov-14 08-Jun-14 A 20-Aug-14 A 0% 100% 0.00 A3430 Material Approval 14.00 13-Nov-14 29-Nov-14 09-Jun-14 A 31-Aug-14 A 0% 100% 0.00 A3440 Issue of PO to Supplier 7.00 30-Nov-14 08-Dec-14 01-Oct-14 11-Oct-14 151.00 0% 0% 0.00 A3450 Manufacturing /Procurement and Delivery of the Material 120.00 09-Dec-14 28-Apr-15 12-Oct-14 03-Mar-15 151.00 0% 0% 0.00 FA System Panels 157.00 19-Mar-14 27-Oct-14 16-Feb-14 A 27-Oct-14 20.00 0% 0% 0.00 A3380 Material Submittal 14.00 19-Mar-14 03-Apr-14 16-Feb-14 A 20-May-14 A 100% 100% 0.00 A3390 Material Approval 14.00 05-Apr-14 20-Apr-14 17-Feb-14 A 04-Jun-14 A 100% 100% 0.00 A3400 Issue of PO to Supplier 7.00 21-Apr-14 28-Apr-14 05-Jun-14 A 23-Jun-14 A 100% 100% 0.00 A3410 Manufacturing /Procurement and Delivery of the Material 150.00 29-Apr-14 27-Oct-14 24-Jun-14 A 27-Oct-14 20.00 86.67% 0% 0.00 HVAC 284.00 26-Mar-14 22-Jul-15 02-Feb-14 A 19-Apr-15 96.00 0% 0% 0.00 FAHU 167.00 23-Apr-14 14-Dec-14 03-Mar-14 A 15-Dec-14 5.00 0% 0% 0.00 A3500 Material Submittal 14.00 23-Apr-14 08-May-14 03-Mar-14 A 20-May-14 A 100% 100% 0.00 A3510 Material Approval 14.00 10-May-14 25-May-14 04-Mar-14 A 10-Jun-14 A 100% 100% 0.00 A3520 Issue of PO to Supplier 7.00 26-May-14 03-Jun-14 11-Jun-14 A 22-Jun-14 A 100% 100% 0.00 A3530 Manufacturing /Procurement and Delivery of the Material 160.00 04-Jun-14 14-Dec-14 23-Jun-14 A 15-Dec-14 5.00 62.5% 61.88% 0.00 FCU 125.00 26-Mar-14 21-Aug-14 09-Feb-14 A 21-Aug-14 A 0% 0% 0.00 A3820 Material Submittal 14.00 26-Mar-14 10-Apr-14 09-Feb-14 A 03-Jul-14 A 100% 100% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 3 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 48.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 A3830 Material Approval 14.00 12-Apr-14 27-Apr-14 10-Feb-14 A 23-Jul-14 A 100% 100% 0.00 A3840 Issue of PO to Supplier 7.00 28-Apr-14 05-May-14 24-Jul-14 A 31-Jul-14 A 100% 100% 0.00 A3850 Manufacturing /Procurement and Delivery of the Material 90.00 06-May-14 21-Aug-14 01-Aug-14 A 21-Aug-14 A 100% 100% 0.00 Fans ( Pressurisation , Parking Extract Etc ) 195.00 29-May-14 19-Jan-15 10-Mar-14 A 09-Dec-14 34.00 0% 0% 0.00 A3460 Material Submittal 14.00 29-May-14 14-Jun-14 10-Mar-14 A 09-Jun-14 A 100% 100% 0.00 A3470 Material Approval 14.00 15-Jun-14 30-Jun-14 11-Mar-14 A 01-Jul-14 A 100% 100% 0.00 A3480 Issue of PO to Supplier 7.00 01-Jul-14 08-Jul-14 02-Jul-14 A 22-Jul-14 A 100% 100% 0.00 A3490 Manufacturing /Procurement and Delivery of the Material 160.00 09-Jul-14 19-Jan-15 23-Jul-14 A 09-Dec-14 34.00 43.75% 65% 0.00 Chilled Water Pumps 195.00 29-May-14 19-Jan-15 05-Mar-14 A 18-Mar-15 -50.00 0% 0% 0.00 A3540 Material Submittal 14.00 29-May-14 14-Jun-14 05-Mar-14 A 03-Jul-14 A 100% 100% 0.00 A3550 Material Approval 14.00 15-Jun-14 30-Jun-14 06-Mar-14 A 19-Jul-14 A 100% 100% 0.00 A3560 Issue of PO to Supplier 7.00 01-Jul-14 08-Jul-14 20-Jul-14 A 24-Aug-14 A 100% 100% 0.00 A3570 Manufacturing /Procurement and Delivery of the Material 160.00 09-Jul-14 19-Jan-15 25-Aug-14 A 18-Mar-15 -50.00 43.75% 12.5% 0.00 Cooling Tower 257.00 03-Dec-14 22-Jul-15 25-May-14 A 19-Apr-15 96.00 0% 0% 0.00 A3580 Material Submittal 14.00 03-Dec-14 18-Dec-14 25-May-14 A 12-Aug-14 A 0% 100% 0.00 A3590 Material Approval 14.00 20-Dec-14 05-Jan-15 26-May-14 A 13-Aug-14 A 0% 100% 0.00 A3600 Issue of PO to Supplier 7.00 06-Jan-15 13-Jan-15 01-Oct-14 11-Oct-14 96.00 0% 0% 0.00 A3610 Manufacturing /Procurement and Delivery of the Material 160.00 14-Jan-15 22-Jul-15 12-Oct-14 19-Apr-15 96.00 0% 0% 0.00 Chiller 215.00 22-May-14 05-Feb-15 08-Mar-14 A 15-Mar-15 4.00 0% 0% 0.00 A3620 Material Submittal 14.00 22-May-14 08-Jun-14 08-Mar-14 A 09-Jun-14 A 100% 100% 0.00 A3630 Material Approval 14.00 09-Jun-14 24-Jun-14 09-Mar-14 A 19-Jun-14 A 100% 100% 0.00 A3640 Issue of PO to Supplier 7.00 25-Jun-14 02-Jul-14 21-Jun-14 A 22-Jun-14 A 100% 100% 0.00 A3650 Manufacturing /Procurement and Delivery of the Material 180.00 03-Jul-14 05-Feb-15 24-Jun-14 A 15-Mar-15 4.00 41.67% 23.89% 0.00 Heat Exchanger 195.00 30-Apr-14 21-Dec-14 02-Feb-14 A 19-Nov-14 36.00 0% 0% 0.00 A3660 Material Submittal 14.00 30-Apr-14 15-May-14 02-Feb-14 A 13-May-14 A 100% 100% 0.00 A3670 Material Approval 14.00 17-May-14 02-Jun-14 03-Feb-14 A 01-Jun-14 A 100% 100% 0.00 A3680 Issue of PO to Supplier 7.00 03-Jun-14 10-Jun-14 02-Jun-14 A 22-Jul-14 A 100% 100% 0.00 A3690 Manufacturing /Procurement and Delivery of the Material 160.00 11-Jun-14 21-Dec-14 23-Jul-14 A 19-Nov-14 36.00 58.75% 75% 0.00 Fire Fighting 215.00 22-May-14 03-Jun-15 01-May-14 A 15-Jun-15 45.00 0% 0% 0.00 Fire Pumps 187.00 22-May-14 05-Feb-15 01-May-14 A 12-May-15 -43.00 0% 0% 0.00 A3700 Material Submittal 14.00 22-May-14 08-Jun-14 01-May-14 A 18-May-14 A 100% 100% 0.00 A3710 Material Approval 14.00 09-Jun-14 24-Jun-14 19-May-14 A 05-Jun-14 A 100% 100% 0.00 A3720 Issue of PO to Supplier 7.00 25-Jun-14 02-Jul-14 01-Oct-14 11-Oct-14 -43.00 100% 0% 0.00 A3730 Manufacturing /Procurement and Delivery of the Material 180.00 03-Jul-14 05-Feb-15 12-Oct-14 12-May-15 -43.00 41.67% 0% 0.00 FM200 215.00 20-Sep-14 03-Jun-15 01-Oct-14 15-Jun-15 45.00 0% 0% 0.00 A4020 Material Submittal 14.00 20-Sep-14 07-Oct-14 01-Oct-14 19-Oct-14 45.00 71.43% 0% 0.00 A4030 Material Approval 14.00 08-Oct-14 23-Oct-14 20-Oct-14 05-Nov-14 45.00 0% 0% 0.00 A4040 Issue of PO to Supplier 7.00 26-Oct-14 02-Nov-14 06-Nov-14 13-Nov-14 45.00 0% 0% 0.00 A4050 Manufacturing /Procurement and Delivery of the Material 180.00 03-Nov-14 03-Jun-15 15-Nov-14 15-Jun-15 45.00 0% 0% 0.00 Plumbing 319.00 14-Sep-14 18-Mar-15 14-Jan-14 A 03-Mar-15 96.00 0% 0% 0.00 Sump Pump 192.00 14-Sep-14 18-Mar-15 29-Jun-14 A 03-Mar-15 96.00 0% 0% 0.00 A3780 Material Submittal 14.00 14-Sep-14 29-Sep-14 29-Jun-14 A 04-Aug-14 A 100% 100% 0.00 A3790 Material Approval 14.00 30-Sep-14 18-Oct-14 30-Jun-14 A 14-Aug-14 A 7.14% 100% 0.00 A3800 Issue of PO to Supplier 7.00 19-Oct-14 27-Oct-14 01-Oct-14 11-Oct-14 96.00 0% 0% 0.00 A3810 Manufacturing /Procurement and Delivery of the Material 120.00 28-Oct-14 18-Mar-15 12-Oct-14 03-Mar-15 96.00 0% 0% 0.00 Water Heat er 155.00 14-Sep-14 18-Mar-15 14-Jan-14 A 31-May-14 A 0% 0% 0.00 A3860 Material Submittal 14.00 14-Sep-14 29-Sep-14 14-Jan-14 A 16-Apr-14 A 100% 100% 0.00 A3880 Issue of PO to Supplier 7.00 19-Oct-14 27-Oct-14 04-May-14 A 14-May-14 A 0% 100% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Issue of PO to Supplier DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 4 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 49.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 A3870 Material Approval 14.00 30-Sep-14 18-Oct-14 15-May-14 A 20-May-14 A 7.14% 100% 0.00 A3890 Manufacturing /Procurement and Delivery of the Material 120.00 28-Oct-14 18-Mar-15 21-May-14 A 31-May-14 A 0% 100% 0.00 Booster Pump 192.00 14-Sep-14 18-Mar-15 03-Jun-14 A 03-Mar-15 96.00 0% 0% 0.00 A3900 Material Submittal 14.00 14-Sep-14 29-Sep-14 03-Jun-14 A 29-Jun-14 A 100% 100% 0.00 A3910 Material Approval 14.00 30-Sep-14 18-Oct-14 04-Jun-14 A 08-Jul-14 A 7.14% 100% 0.00 A3920 Issue of PO to Supplier 7.00 19-Oct-14 27-Oct-14 01-Oct-14 11-Oct-14 96.00 0% 0% 0.00 A3930 Manufacturing /Procurement and Delivery of the Material 120.00 28-Oct-14 18-Mar-15 12-Oct-14 03-Mar-15 96.00 0% 0% 0.00 Transfer Pump 192.00 14-Sep-14 18-Mar-15 03-Jun-14 A 03-Mar-15 96.00 0% 0% 0.00 A3940 Material Submittal 14.00 14-Sep-14 29-Sep-14 03-Jun-14 A 29-Jun-14 A 100% 100% 0.00 A3950 Material Approval 14.00 30-Sep-14 18-Oct-14 04-Jun-14 A 08-Jul-14 A 7.14% 100% 0.00 A3960 Issue of PO to Supplier 7.00 19-Oct-14 27-Oct-14 01-Oct-14 11-Oct-14 96.00 0% 0% 0.00 A3970 Manufacturing /Procurement and Delivery of the Material 120.00 28-Oct-14 18-Mar-15 12-Oct-14 03-Mar-15 96.00 0% 0% 0.00 Sewage Pump 192.00 14-Sep-14 18-Mar-15 29-Jun-14 A 03-Mar-15 96.00 0% 0% 0.00 A3980 Material Submittal 14.00 14-Sep-14 29-Sep-14 29-Jun-14 A 04-Aug-14 A 100% 100% 0.00 A3990 Material Approval 14.00 30-Sep-14 18-Oct-14 30-Jun-14 A 14-Aug-14 A 7.14% 100% 0.00 A4000 Issue of PO to Supplier 7.00 19-Oct-14 27-Oct-14 01-Oct-14 11-Oct-14 96.00 0% 0% 0.00 A4010 Manufacturing /Procurement and Delivery of the Material 120.00 28-Oct-14 18-Mar-15 12-Oct-14 03-Mar-15 96.00 0% 0% 0.00 DOMESTIC SUBCONTRACTORS 1589.00 24-Feb-14 22-Mar-15 19-Jun-11 A 24-Oct-15 186.00 0% 0% 0.00 Prime Cost 363.00 01-Apr-14 28-Sep-15 24-Feb-14 A 28-Sep-15 65.00 0% 0% 0.00 SUB-STRUCTURE 938.00 24-Feb-14 24-Feb-14 22-Jun-11 A 20-Sep-13 A 0% 0% 0.00 SUPER STRUCTURE 1633.00 24-Feb-14 13-Jul-15 11-Apr-13 A 02-Feb-16 A 0% 0% 0.00 MEP 1835.00 24-Feb-14 07-Dec-15 24-Feb-14 A 24-Feb-14 A 0% 0% 0.00 CONSTRUCTION 1603.00 24-Feb-14 30-Apr-16 26-Jun-11 A 27-Aug-16 -88.00 25.09% 22.48% 0.90 STRUCTURAL , ARCHITECTURAL , MEP 1530.00 24-Feb-14 30-Apr-16 26-Jun-11 A 31-May-16 -15.00 29.36% 28.06% 0.96 FOUNDATION WORKS 1363.00 24-Feb-14 11-Oct-15 26-Jun-11 A 16-Nov-15 -4.00 75.13% 71.94% 0.96 BASEMENT & PODIUM 1455.00 24-Feb-14 30-Apr-16 31-May-13 A 23-May-16 -8.00 48.62% 48.59% 1.00 TOWER 696.00 24-Feb-14 06-Apr-16 10-Feb-14 A 31-May-16 -45.00 24.04% 22.56% 0.94 LEVELS 06 - 29 577.00 24-Feb-14 14-Nov-15 10-Feb-14 A 12-Jan-16 -50.00 68.5% 64.97% 0.95 LEVEL 06 468.00 24-Feb-14 21-May-15 10-Feb-14 A 02-Sep-15 -72.00 76.72% 72.35% 0.94 STRUCTURAL - LEVEL 6 20.00 24-Feb-14 16-Mar-14 10-Feb-14 A 09-Mar-14 A 100% 100% 1.00 DHCWA07100 Core Wal - Level 06 6.00 24-Feb-14 24-Feb-14 15-Feb-14 A 20-Feb-14 A 100% 100% 1.00 DHSLA06100 Construction of Horizontals - L06 4.00 10-Mar-14 11-Mar-14 10-Feb-14 A 04-Mar-14 A 100% 100% 1.00 DHCWA07110 Construction of Verticals - L06 3.00 13-Mar-14 16-Mar-14 06-Mar-14 A 09-Mar-14 A 100% 100% 1.00 STAIRCASES 4.00 25-May-14 29-May-14 08-May-14 A 18-May-14 A 0% 0% 0.00 DHSLA06102 Stair # 2 4.00 25-May-14 29-May-14 08-May-14 A 13-May-14 A 100% 100% 0.00 DHSLA06104 Stair # 1 4.00 25-May-14 29-May-14 13-May-14 A 18-May-14 A 100% 100% 0.00 FINISHES - LEVEL 06 246.00 12-Apr-14 21-May-15 24-Feb-14 A 14-Jul-15 -31.00 40.01% 18.14% 0.45 Dry area 230.00 06-May-14 02-May-15 28-Apr-14 A 25-Jun-15 -43.00 30.8% 15.86% 0.51 DHFSH06100 Block Work in Dry Area 6.00 06-May-14 12-May-14 28-Apr-14 A 19-May-14 A 100% 100% 1.00 DHFSH06120 Marking,Cutting & Chasing - Dry Area 4.00 13-May-14 17-May-14 15-May-14 A 03-Jun-14 A 100% 100% 1.00 DHFSH06130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 08-Jun-14 12-Jun-14 21-May-14 A 07-Jun-14 A 100% 100% 1.00 DHFSH06160 Plaster in Dry Area 8.00 12-Jun-14 22-Jun-14 25-May-14 A 18-Jun-14 A 100% 100% 1.00 DHFSH06190 Dry Area Floor Screed 7.00 22-Jun-14 30-Jun-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00 DHFSH06230 Dry Area Painting - Primer 4.00 30-Jun-14 05-Jul-14 01-Sep-14 A 01-Oct-14 -8.00 100% 80% 0.00 DHFSH06260 Dry Area Painting - Stucco 6.00 05-Jul-14 12-Jul-14 06-Sep-14 A 06-Oct-14 48.00 100% 60% 0.00 DHFSH06290 Dry Area False Ceiling Suspension 6.00 23-Aug-14 30-Aug-14 02-Sep-14 A 09-Oct-14 -8.00 100% 15% 0.15 DHFSH06350 Dry Area False Ceiling Tiling / Boarding 5.00 17-Sep-14 23-Sep-14 14-Oct-14 19-Oct-14 37.00 100% 0% 0.00 DHFSH06400 Dry Area Painting - 1st Coat 5.00 23-Sep-14 29-Sep-14 20-Oct-14 26-Oct-14 37.00 100% 0% 0.00 DHFSH06450 Dry Area Flooring 5.00 12-Oct-14 18-Oct-14 02-Nov-14 06-Nov-14 32.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Material Approval Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Material Submittal Material Approval Issue of PO to Supplier Manufacturing /Procurement and Delivery of the Material Construction of Horizontals - L06 Construction of Verticals - L06 Stair # 2 Stair # 1 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 5 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 50.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH06430 Installation of Timber Doors & Ironmongery 5.00 22-Mar-15 26-Mar-15 20-May-15 25-May-15 -50.00 0% 0% 0.00 DHFSH06802 Installation of Wardrobe 12.00 22-Mar-15 04-Apr-15 20-May-15 02-Jun-15 -50.00 0% 0% 0.00 DHFSH06500 Paint Final Coat 6.00 26-Apr-15 02-May-15 20-Jun-15 25-Jun-15 -43.00 0% 0% 0.00 Wet area 204.00 13-May-14 04-Apr-15 24-Feb-14 A 02-Jun-15 -45.00 43.27% 24.17% 0.56 DHFSH06220 Wet Area Floor Screed 4.00 29-Sep-14 06-Oct-14 24-Feb-14 A 24-Feb-14 A 28.13% 100% 0.00 DHFSH06110 Block Work in Wet Area 6.00 13-May-14 19-May-14 28-Apr-14 A 19-May-14 A 100% 100% 0.00 DHFSH06140 Marking,Cutting & Chasing - Wet Area 4.00 20-May-14 24-May-14 15-May-14 A 03-Jun-14 A 100% 100% 1.00 DHFSH06150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 08-Jun-14 12-Jun-14 21-May-14 A 07-Jun-14 A 100% 100% 1.00 DHFSH06170 Plaster in Wet Area 4.00 12-Jun-14 17-Jun-14 25-May-14 A 18-Jun-14 A 100% 100% 1.00 DHFSH06180 Wet Area Wall Tiling 6.00 23-Aug-14 30-Aug-14 02-Sep-14 A 02-Oct-14 -23.00 100% 60% 0.60 DHFSH06300 Wet Area False Ceiling Suspension 5.00 01-Sep-14 07-Sep-14 11-Oct-14 15-Oct-14 7.00 100% 0% 0.00 DHFSH06370 Wet Area False Ceiling Tiling/Boarding 6.00 17-Sep-14 24-Sep-14 14-Oct-14 20-Oct-14 15.00 100% 0% 0.00 DHFSH06210 Wet Area Waterproofing 4.00 24-Sep-14 29-Sep-14 16-Sep-14 A 26-Oct-14 15.00 100% 10% 0.10 DHFSH06250 Wet Area Floor Tiling 5.00 06-Oct-14 12-Oct-14 27-Oct-14 01-Nov-14 15.00 0% 0% 0.00 DHFSH06460 Cabinet Carcass 5.00 18-Oct-14 22-Oct-14 02-Nov-14 06-Nov-14 15.00 0% 0% 0.00 DHFSH06420 Installation of Shower Enclosure 4.00 28-Mar-15 31-Mar-15 26-May-15 30-May-15 -42.00 0% 0% 0.00 DHFSH06390 Installation of Vanity Counters & Tops 5.00 28-Mar-15 01-Apr-15 26-May-15 31-May-15 -50.00 0% 0% 0.00 DHFSH06800 Installation of Kitchen Cabinet 12.00 22-Mar-15 04-Apr-15 20-May-15 02-Jun-15 -50.00 0% 0% 0.00 Corridor/ Lift Lobby 44.00 30-Jun-14 10-Mar-15 01-Sep-14 A 24-Nov-14 89.00 66.67% 0% 0.00 DHFSH06240 Corridor/Lift Lobby Floor Screed 4.00 30-Jun-14 05-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00 DHFSH06270 Lift Lobby Painting - Primer & Stucco 6.00 05-Jul-14 12-Jul-14 01-Sep-14 A 02-Oct-14 13.00 100% 75% 0.00 DHFSH06310 Lift Lobby False Ceiling Suspension 6.00 03-Sep-14 10-Sep-14 13-Oct-14 19-Oct-14 7.00 100% 0% 0.00 DHFSH06360 Lift Lobby False Ceiling Tiling / Boarding 5.00 17-Sep-14 23-Sep-14 20-Oct-14 26-Oct-14 93.00 100% 0% 0.00 DHFSH06410 Lift Lobby Painting - 1st Coat 6.00 23-Sep-14 30-Sep-14 27-Oct-14 02-Nov-14 93.00 100% 0% 0.00 DHFSH06470 Lift Lobby Flooring 6.00 18-Oct-14 26-Oct-14 08-Nov-14 13-Nov-14 89.00 0% 0% 0.00 DHFSH06490 Utility Rooms- Epoxy Flooring 6.00 26-Oct-14 02-Nov-14 15-Nov-14 20-Nov-14 89.00 0% 0% 0.00 DHFSH06440 Installation of Steel Doors & Windows 3.00 08-Mar-15 10-Mar-15 22-Nov-14 24-Nov-14 89.00 0% 0% 0.00 Staircase 51.00 22-Jun-14 18-Mar-15 01-Oct-14 03-Dec-14 91.00 45.08% 0% 0.00 DHFSH06200 Staircase Plastering 4.00 22-Jun-14 26-Jun-14 01-Oct-14 07-Oct-14 27.00 100% 0% 0.00 DHFSH06280 Staircase Painting - Primer & Stucco 6.00 12-Jul-14 19-Jul-14 08-Oct-14 14-Oct-14 119.00 100% 0% 0.00 DHFSH06320 Staircase Handrail Fixing 3.00 04-Dec-14 08-Dec-14 15-Oct-14 18-Oct-14 119.00 0% 0% 0.00 DHFSH06330 Staircase Painting 1st Coat 3.00 08-Dec-14 11-Dec-14 27-Oct-14 29-Oct-14 113.00 0% 0% 0.00 DHFSH06340 Staircase Final Painting 5.00 11-Mar-15 16-Mar-15 25-Nov-14 30-Nov-14 91.00 0% 0% 0.00 DHFSH06380 Staircase Epoxy Flooring 2.00 17-Mar-15 18-Mar-15 01-Dec-14 03-Dec-14 91.00 0% 0% 0.00 General 246.00 12-Apr-14 21-May-15 03-Apr-14 A 14-Jul-15 -43.00 0% 0% 0.00 DHSTR06000 Access from Structure 0.00 12-Apr-14 03-Apr-14 A 100% 100% 0.00 DHFSH06510 Snagging & De-Snagging 16.00 03-May-15 21-May-15 27-Jun-15 14-Jul-15 -43.00 0% 0% 0.00 Show Flats 1 & 2 116.00 12-Jul-14 29-Nov-14 01-Oct-14 18-Feb-15 93.00 0% 0% 0.00 DHFSH06511 Finishes & MEP Works - Flat 1 (Workmanship) 116.00 12-Jul-14 29-Nov-14 01-Oct-14 18-Feb-15 93.00 58.62% 0% 0.00 DHFSH06512 Finishes & MEP Works - Flat 2 (Workmanship) 116.00 12-Jul-14 29-Nov-14 01-Oct-14 18-Feb-15 93.00 58.62% 0% 0.00 MEP - LEVEL 06 465.00 08-Mar-14 25-Apr-15 10-Feb-14 A 02-Sep-15 -106.00 70.98% 70.98% 1.00 DHMEP06000 Embeded Conduits & Boxex - Concrete Works 4.00 08-Mar-14 11-Mar-14 10-Feb-14 A 04-Mar-14 A 100% 100% 0.00 DHMEP06100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C15a-bAlipnrg-1 ,4 Wiring et0c5-May-14 03-Apr-14 A 29-Apr-14 A 100% 100% 1.00 DHMEP06130 Cable Trays & Cable Trunking 6.00 13-May-14 19-May-14 03-Apr-14 A 29-Apr-14 A 100% 100% 0.00 DHMEP06160 Pressure Testing of Pipes 12.00 23-Aug-14 04-Sep-14 28-Apr-14 A 17-May-14 A 100% 100% 0.00 DHMEP06120 Embeded Condiuts,Boxes ,Sleeves and Pix Pipes in Walls 6.00 25-May-14 01-Jun-14 20-May-14 A 05-Jun-14 A 100% 100% 1.00 DHMEP06110 MEP Works in Risers& Clearance 5.00 12-Jul-14 16-Jul-14 05-Apr-14 A 01-Oct-14 -33.00 100% 78% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Wet Area Floor Screed Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Lift Lobby Flooring Utility Rooms- Epoxy Flooring Installation of Steel Doors & Windows Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Finishes & MEP Works - Flat 1 (Workmanship) Finishes & MEP Works - Flat 2 (Workmanship) Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Pressure Testing of Pipes Embeded Condiuts,Boxes ,Sleeves and Pix Pipes in Walls MEP Works in Risers& Clearance DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 6 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 51.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHMEP06140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es10-Sep-14 17-Sep-14 01-Jun-14 A 13-Oct-14 15.00 100% 71% 0.00 DHMEP06150 MEP Final Fixes 6.00 06-Apr-15 12-Apr-15 01-Jun-15 07-Jun-15 -43.00 0% 0% 0.00 DHMEP06170 Sanitary ware /Toilet accessories 6.00 11-Apr-15 16-Apr-15 04-Jun-15 10-Jun-15 -43.00 0% 0% 0.00 DHMEP06200 Pre-Testing & Commissioning 7.00 18-Apr-15 25-Apr-15 11-Jun-15 18-Jun-15 -43.00 0% 0% 0.00 DHMEP06690 Busbar - L6 to L10 20.00 17-Feb-15 11-Mar-15 11-Aug-15 02-Sep-15 -144.00 0% 0% 0.00 LEVEL 07 433.00 24-Feb-14 04-Jun-15 20-Feb-14 A 30-Jul-15 -43.00 77.04% 72.04% 0.94 STRUCTURAL - LEVEL 07 21.00 24-Feb-14 24-Mar-14 20-Feb-14 A 20-Mar-14 A 100% 100% 1.00 DHCWA08100 Core Wal - Level 07 9.00 24-Feb-14 05-Mar-14 20-Feb-14 A 28-Feb-14 A 100% 100% 1.00 DHSLA07100 Construction of Horizontals - L07 4.00 17-Mar-14 20-Mar-14 06-Mar-14 A 16-Mar-14 A 100% 100% 1.00 DHCWA08110 Construction of Verticals - L07 3.00 22-Mar-14 24-Mar-14 16-Mar-14 A 20-Mar-14 A 100% 100% 1.00 STAIRCASES 4.00 02-Jun-14 05-Jun-14 17-May-14 A 24-May-14 A 0% 0% 0.00 A1330 Stair # 2 4.00 02-Jun-14 05-Jun-14 17-May-14 A 22-May-14 A 100% 100% 0.00 A1320 Stair # 1 4.00 02-Jun-14 05-Jun-14 18-May-14 A 24-May-14 A 100% 100% 0.00 FINISHES - LEVEL 07 258.00 19-Apr-14 04-Jun-15 14-Apr-14 A 30-Jul-15 -43.00 45.11% 22.06% 0.49 Dry area 232.00 12-May-14 09-May-15 03-May-14 A 02-Jul-15 -33.00 45.17% 35.49% 0.79 DHFSH07100 Block Work in Dry Area 6.00 12-May-14 18-May-14 03-May-14 A 24-May-14 A 100% 100% 1.00 DHFSH07120 Marking,Cutting & Chasing - Dry Area 4.00 19-May-14 22-May-14 25-May-14 A 10-Jun-14 A 100% 100% 1.00 DHFSH07130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 24-May-14 28-May-14 16-Jun-14 A 22-Jun-14 A 100% 100% 1.00 DHFSH07160 Plaster in Dry Area 8.00 19-Jun-14 29-Jun-14 18-Jun-14 A 24-Jun-14 A 100% 100% 1.00 DHFSH07190 Dry Area Floor Screed 7.00 29-Jun-14 07-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00 DHFSH07230 Dry Area Painting - Primer 4.00 07-Jul-14 12-Jul-14 04-Sep-14 A 01-Oct-14 -1.00 100% 80% 0.00 DHFSH07260 Dry Area Painting - Stucco 6.00 12-Jul-14 19-Jul-14 09-Sep-14 A 06-Oct-14 53.00 100% 60% 0.00 DHFSH07290 Dry Area False Ceiling Suspension 6.00 27-Aug-14 03-Sep-14 08-Oct-14 14-Oct-14 -8.00 100% 0% 0.00 DHFSH07350 Dry Area False Ceiling Tiling / Boarding 5.00 21-Sep-14 27-Sep-14 02-Nov-14 06-Nov-14 27.00 100% 0% 0.00 DHFSH07400 Dry Area Painting - 1st Coat 5.00 27-Sep-14 02-Oct-14 08-Nov-14 12-Nov-14 27.00 62.5% 0% 0.00 DHFSH07450 Dry Area Flooring 5.00 18-Oct-14 23-Oct-14 22-Nov-14 26-Nov-14 20.00 0% 0% 0.00 DHFSH07430 Installation of Timber Doors & Ironmongery 5.00 28-Mar-15 01-Apr-15 26-May-15 31-May-15 -50.00 0% 0% 0.00 DHFSH07802 Installation of Wardrobe 12.00 05-Apr-15 18-Apr-15 03-Jun-15 16-Jun-15 -50.00 0% 0% 0.00 DHFSH07500 Paint Final Coat 6.00 03-May-15 09-May-15 27-Jun-15 02-Jul-15 -33.00 0% 0% 0.00 Wet area 218.00 12-May-14 18-Apr-15 03-May-14 A 16-Jun-15 -50.00 43.27% 15.42% 0.36 DHFSH07110 Block Work in Wet Area 6.00 12-May-14 18-May-14 03-May-14 A 24-May-14 A 100% 100% 0.00 DHFSH07140 Marking,Cutting & Chasing - Wet Area 4.00 19-May-14 22-May-14 25-May-14 A 10-Jun-14 A 100% 100% 1.00 DHFSH07150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 24-May-14 28-May-14 16-Jun-14 A 22-Jun-14 A 100% 100% 1.00 DHFSH07170 Plaster in Wet Area 4.00 16-Jun-14 21-Jun-14 18-Jun-14 A 24-Jun-14 A 100% 100% 1.00 DHFSH07180 Wet Area Wall Tiling 6.00 27-Aug-14 03-Sep-14 09-Sep-14 A 09-Oct-14 1.00 100% 20% 0.20 DHFSH07300 Wet Area False Ceiling Suspension 5.00 03-Sep-14 09-Sep-14 15-Oct-14 20-Oct-14 3.00 100% 0% 0.00 DHFSH07370 Wet Area False Ceiling Tiling/Boarding 4.00 21-Sep-14 25-Sep-14 02-Nov-14 05-Nov-14 3.00 100% 0% 0.00 DHFSH07210 Wet Area Waterproofing 4.00 25-Sep-14 30-Sep-14 22-Sep-14 A 10-Nov-14 3.00 100% 10% 0.10 DHFSH07220 Wet Area Floor Screed 4.00 30-Sep-14 07-Oct-14 11-Nov-14 15-Nov-14 3.00 3.13% 0% 0.00 DHFSH07250 Wet Area Floor Tiling 5.00 07-Oct-14 13-Oct-14 16-Nov-14 20-Nov-14 3.00 0% 0% 0.00 DHFSH06480 Cabinet Carcass 5.00 23-Oct-14 29-Oct-14 22-Nov-14 26-Nov-14 3.00 0% 0% 0.00 DHFSH07420 Installation of Shower Enclosure 4.00 02-Apr-15 06-Apr-15 01-Jun-15 04-Jun-15 -41.00 0% 0% 0.00 DHFSH07390 Installation of Vanity Counters & Tops 5.00 02-Apr-15 07-Apr-15 01-Jun-15 06-Jun-15 -50.00 0% 0% 0.00 DHFSH07800 Installation of Kitchen Cabinet 12.00 05-Apr-15 18-Apr-15 03-Jun-15 16-Jun-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 58.00 07-Jul-14 14-Mar-15 01-Sep-14 A 11-Dec-14 123.00 66.67% 0% 0.00 DHFSH07240 Corridor/Lift Lobby Floor Screed 4.00 07-Jul-14 12-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00 DHFSH07270 Lift Lobby Painting - Primer & Stucco 6.00 12-Jul-14 19-Jul-14 04-Sep-14 A 02-Oct-14 16.00 100% 75% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Busbar - L6 to L10 Construction of Horizontals - L07 Construction of Verticals - L07 Stair # 2 Stair # 1 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 7 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 52.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH07310 Lift Lobby False Ceiling Suspension 6.00 09-Sep-14 16-Sep-14 21-Oct-14 28-Oct-14 3.00 100% 0% 0.00 DHFSH07360 Lift Lobby False Ceiling Tiling / Boarding 5.00 21-Sep-14 27-Sep-14 02-Nov-14 06-Nov-14 112.00 100% 0% 0.00 DHFSH07410 Lift Lobby Painting - 1st Coat 6.00 27-Sep-14 06-Oct-14 08-Nov-14 13-Nov-14 112.00 52.08% 0% 0.00 DHFSH07440 Installation of Steel Doors & Windows 3.00 11-Mar-15 14-Mar-15 25-Nov-14 27-Nov-14 89.00 0% 0% 0.00 DHFSH07470 Lift Lobby Flooring 6.00 23-Oct-14 01-Nov-14 27-Nov-14 04-Dec-14 123.00 0% 0% 0.00 DHFSH07490 Utility Rooms- Epoxy Flooring 6.00 01-Nov-14 08-Nov-14 06-Dec-14 11-Dec-14 123.00 0% 0% 0.00 Staircase 54.00 29-Jun-14 22-Mar-15 01-Oct-14 07-Dec-14 96.00 45.08% 0% 0.00 DHFSH07200 Staircase Plastering 4.00 29-Jun-14 03-Jul-14 01-Oct-14 07-Oct-14 124.00 100% 0% 0.00 DHFSH07280 Staircase Painting - Primer & Stucco 6.00 19-Jul-14 26-Jul-14 08-Oct-14 14-Oct-14 124.00 100% 0% 0.00 DHFSH07320 Staircase Handrail Fixing 3.00 08-Dec-14 11-Dec-14 19-Oct-14 21-Oct-14 123.00 0% 0% 0.00 DHFSH07330 Staircase Painting 1st Coat 3.00 11-Dec-14 15-Dec-14 13-Nov-14 16-Nov-14 105.00 0% 0% 0.00 DHFSH07340 Staircase Final Painting 5.00 15-Mar-15 19-Mar-15 29-Nov-14 04-Dec-14 96.00 0% 0% 0.00 DHFSH07380 Staircase Epoxy Flooring 2.00 21-Mar-15 22-Mar-15 06-Dec-14 07-Dec-14 96.00 0% 0% 0.00 General 258.00 19-Apr-14 04-Jun-15 14-Apr-14 A 30-Jul-15 -43.00 0% 0% 0.00 DHSTR07000 Access from Structure 0.00 19-Apr-14 14-Apr-14 A 100% 100% 0.00 DHFSH07510 Snagging & De-Snagging 12.00 23-May-15 04-Jun-15 15-Jul-15 30-Jul-15 -43.00 0% 0% 0.00 MEP - LEVEL 07 398.00 17-Mar-14 02-May-15 06-Mar-14 A 25-Jun-15 -43.00 70.98% 70.98% 1.00 DHMEP07000 Embeded Conduits & Boxex - Concrete Works 4.00 17-Mar-14 20-Mar-14 06-Mar-14 A 16-Mar-14 A 100% 100% 0.00 DHMEP07100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C21a-bAlipnrg-1 ,4 Wiring et1c1-May-14 14-Apr-14 A 28-May-14 A 100% 100% 1.00 DHMEP07130 Cable Trays & Cable Trunking 6.00 19-May-14 25-May-14 14-Apr-14 A 28-May-14 A 100% 100% 0.00 DHMEP07120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 24-May-14 31-May-14 01-Jun-14 A 12-Jun-14 A 100% 100% 1.00 DHMEP07160 Pressure Testing of Pipes 12.00 01-Jun-14 14-Jun-14 07-May-14 A 10-Jul-14 A 100% 100% 0.00 DHMEP07110 MEP Works in Risers& Clearance 5.00 17-Jul-14 22-Jul-14 17-Apr-14 A 02-Oct-14 -33.00 100% 78% 0.00 DHMEP07140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es14-Sep-14 21-Sep-14 01-Jul-14 A 01-Nov-14 3.00 100% 71% 0.00 DHMEP07150 MEP Final Fixes 6.00 11-Apr-15 16-Apr-15 07-Jun-15 13-Jun-15 -42.00 0% 0% 0.00 DHMEP06180 Sanitary ware /Toilet accessories 6.00 14-Apr-15 20-Apr-15 10-Jun-15 16-Jun-15 -42.00 0% 0% 0.00 DHMEP07200 Pre-Testing & Commissioning 7.00 25-Apr-15 02-May-15 18-Jun-15 25-Jun-15 -43.00 0% 0% 0.00 LEVEL 08 434.00 06-Mar-14 11-Jun-15 01-Mar-14 A 06-Aug-15 -43.00 76.28% 70.79% 0.93 STRUCTURAL WORKS - LEVEL 08 22.00 06-Mar-14 31-Mar-14 01-Mar-14 A 28-Mar-14 A 100% 100% 1.00 DHCWA09100 Core Wal - Level 08 9.00 06-Mar-14 16-Mar-14 01-Mar-14 A 11-Mar-14 A 100% 100% 1.00 DHSLA08100 Construction of Horizontals - L08 4.00 24-Mar-14 27-Mar-14 16-Mar-14 A 24-Mar-14 A 100% 100% 1.00 DHCWA09110 Construction of Verticals - L08 3.00 29-Mar-14 31-Mar-14 25-Mar-14 A 28-Mar-14 A 100% 100% 1.00 STAIRCASES 4.00 08-Jun-14 11-Jun-14 22-May-14 A 31-May-14 A 0% 0% 0.00 A1350 Stair # 2 4.00 08-Jun-14 11-Jun-14 22-May-14 A 28-May-14 A 100% 100% 0.00 A1340 Stair # 1 4.00 08-Jun-14 11-Jun-14 25-May-14 A 31-May-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 08 280.00 26-Apr-14 11-Jun-15 19-Apr-14 A 06-Aug-15 -43.00 41.91% 20.02% 0.48 Dry area 236.00 19-May-14 17-May-15 11-May-14 A 09-Jul-15 -33.00 41.79% 35.49% 0.85 DHFSH08100 Block Work in Dry Area 6.00 19-May-14 25-May-14 11-May-14 A 31-May-14 A 100% 100% 1.00 DHFSH08120 Marking,Cutting & Chasing - Dry Area 4.00 26-May-14 31-May-14 28-May-14 A 12-Jun-14 A 100% 100% 1.00 DHFSH08130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 01-Jun-14 04-Jun-14 29-Jun-14 A 09-Jul-14 A 100% 100% 1.00 DHFSH08160 Plaster in Dry Area 8.00 24-Jun-14 03-Jul-14 06-Jul-14 A 28-Aug-14 A 100% 100% 1.00 DHFSH08190 Dry Area Floor Screed 7.00 03-Jul-14 12-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00 DHFSH08230 Dry Area Painting - Primer 4.00 12-Jul-14 16-Jul-14 06-Sep-14 A 01-Oct-14 -5.00 100% 0% 0.00 DHFSH08260 Dry Area Painting - Stucco 6.00 16-Jul-14 23-Jul-14 10-Sep-14 A 06-Oct-14 58.00 100% 0% 0.00 DHFSH08290 Dry Area False Ceiling Suspension 6.00 01-Sep-14 08-Sep-14 13-Oct-14 19-Oct-14 -8.00 100% 0% 0.00 DHFSH08350 Dry Area False Ceiling Tiling / Boarding 5.00 24-Sep-14 30-Sep-14 05-Nov-14 10-Nov-14 29.00 100% 0% 0.00 DHFSH08400 Dry Area Painting - 1st Coat 5.00 30-Sep-14 08-Oct-14 11-Nov-14 16-Nov-14 29.00 2.5% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Construction of Horizontals - L08 Construction of Verticals - L08 Stair # 2 Stair # 1 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 8 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 53.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH08450 Dry Area Flooring 5.00 23-Oct-14 30-Oct-14 27-Nov-14 03-Dec-14 20.00 0% 0% 0.00 DHFSH08430 Installation of Timber Doors & Ironmongery 5.00 02-Apr-15 07-Apr-15 01-Jun-15 06-Jun-15 -50.00 0% 0% 0.00 DHFSH08802 Installation of Wardrobe 12.00 19-Apr-15 02-May-15 17-Jun-15 30-Jun-15 -50.00 0% 0% 0.00 DHFSH08500 Paint Final Coat 6.00 10-May-15 17-May-15 04-Jul-15 09-Jul-15 -33.00 0% 0% 0.00 Wet area 224.00 19-May-14 02-May-15 11-May-14 A 30-Jun-15 -50.00 39.44% 11.04% 0.28 DHFSH08110 Block Work in Wet Area 6.00 19-May-14 25-May-14 11-May-14 A 31-May-14 A 100% 100% 0.00 DHFSH08140 Marking,Cutting & Chasing - Wet Area 4.00 26-May-14 31-May-14 28-May-14 A 12-Jun-14 A 100% 100% 1.00 DHFSH08150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 01-Jun-14 04-Jun-14 29-Jun-14 A 09-Jul-14 A 100% 100% 1.00 DHFSH08170 Plaster in Wet Area 4.00 19-Jun-14 24-Jun-14 06-Jul-14 A 28-Aug-14 A 100% 100% 1.00 DHFSH08180 Wet Area Wall Tiling 6.00 01-Sep-14 08-Sep-14 08-Oct-14 14-Oct-14 1.00 100% 0% 0.00 DHFSH08300 Wet Area False Ceiling Suspension 5.00 07-Sep-14 13-Sep-14 19-Oct-14 23-Oct-14 5.00 100% 0% 0.00 DHFSH08370 Wet Area False Ceiling Tiling/Boarding 4.00 24-Sep-14 29-Sep-14 05-Nov-14 09-Nov-14 5.00 100% 0% 0.00 DHFSH08210 Wet Area Waterproofing 4.00 29-Sep-14 06-Oct-14 28-Sep-14 A 13-Nov-14 5.00 28.13% 10% 0.36 DHFSH08220 Wet Area Floor Screed 4.00 06-Oct-14 11-Oct-14 15-Nov-14 18-Nov-14 5.00 0% 0% 0.00 DHFSH08250 Wet Area Floor Tiling 5.00 11-Oct-14 16-Oct-14 19-Nov-14 24-Nov-14 5.00 0% 0% 0.00 DHFSH06520 Cabinet Carcass 5.00 30-Oct-14 04-Nov-14 27-Nov-14 03-Dec-14 3.00 0% 0% 0.00 DHFSH08420 Installation of Shower Enclosure 4.00 08-Apr-15 12-Apr-15 07-Jun-15 10-Jun-15 -40.00 0% 0% 0.00 DHFSH08390 Installation of Vanity Counters & Tops 5.00 08-Apr-15 13-Apr-15 07-Jun-15 11-Jun-15 -50.00 0% 0% 0.00 DHFSH08800 Installation of Kitchen Cabinet 12.00 19-Apr-15 02-May-15 17-Jun-15 30-Jun-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 85.00 12-Jul-14 17-Mar-15 01-Sep-14 A 17-Dec-14 121.00 66.67% 0% 0.00 DHFSH08240 Corridor/Lift Lobby Floor Screed 4.00 12-Jul-14 16-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00 DHFSH08270 Lift Lobby Painting - Primer & Stucco 6.00 16-Jul-14 23-Jul-14 06-Sep-14 A 02-Oct-14 21.00 100% 0% 0.00 DHFSH08310 Lift Lobby False Ceiling Suspension 6.00 13-Sep-14 20-Sep-14 26-Oct-14 01-Nov-14 5.00 100% 0% 0.00 DHFSH08360 Lift Lobby False Ceiling Tiling / Boarding 5.00 24-Sep-14 30-Sep-14 05-Nov-14 10-Nov-14 112.00 100% 0% 0.00 DHFSH08410 Lift Lobby Painting - 1st Coat 6.00 30-Sep-14 09-Oct-14 11-Nov-14 17-Nov-14 112.00 2.08% 0% 0.00 DHFSH08440 Installation of Steel Doors & Windows 3.00 15-Mar-15 17-Mar-15 04-Dec-14 07-Dec-14 85.00 0% 0% 0.00 DHFSH08470 Lift Lobby Flooring 6.00 30-Oct-14 06-Nov-14 04-Dec-14 10-Dec-14 121.00 0% 0% 0.00 DHFSH08490 Utility Rooms- Epoxy Flooring 6.00 06-Nov-14 13-Nov-14 11-Dec-14 17-Dec-14 121.00 0% 0% 0.00 Staircase 61.00 03-Jul-14 25-Mar-15 01-Oct-14 15-Dec-14 91.00 45.08% 0% 0.00 DHFSH08200 Staircase Plastering 4.00 03-Jul-14 08-Jul-14 01-Oct-14 07-Oct-14 127.00 100% 0% 0.00 DHFSH08280 Staircase Painting - Primer & Stucco 6.00 23-Jul-14 02-Aug-14 08-Oct-14 14-Oct-14 127.00 100% 0% 0.00 DHFSH08320 Staircase Handrail Fixing 3.00 11-Dec-14 15-Dec-14 22-Oct-14 26-Oct-14 123.00 0% 0% 0.00 DHFSH08330 Staircase Painting 1st Coat 3.00 15-Dec-14 18-Dec-14 17-Nov-14 19-Nov-14 105.00 0% 0% 0.00 DHFSH08340 Staircase Final Painting 5.00 18-Mar-15 23-Mar-15 08-Dec-14 13-Dec-14 91.00 0% 0% 0.00 DHFSH08380 Staircase Epoxy Flooring 2.00 24-Mar-15 25-Mar-15 14-Dec-14 15-Dec-14 91.00 0% 0% 0.00 General 264.00 26-Apr-14 11-Jun-15 19-Apr-14 A 06-Aug-15 -43.00 0% 0% 0.00 DHSTR08000 Access from Structure 0.00 26-Apr-14 19-Apr-14 A 100% 100% 0.00 DHFSH08510 Snagging & De-Snagging 12.00 30-May-15 11-Jun-15 25-Jul-15 06-Aug-15 -43.00 0% 0% 0.00 MEP - LEVEL 08 400.00 24-Mar-14 09-May-15 16-Mar-14 A 02-Jul-15 -43.00 72.62% 70.81% 0.98 DHMEP08000 Embeded Conduits & Boxex - Concrete Works 4.00 24-Mar-14 27-Mar-14 16-Mar-14 A 24-Mar-14 A 100% 100% 0.00 DHMEP08100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C27a-bAlipnrg-1 ,4 Wiring et1c7-May-14 19-Apr-14 A 27-May-14 A 100% 100% 1.00 DHMEP08130 Cable Trays & Cable Trunking 6.00 26-May-14 02-Jun-14 19-Apr-14 A 27-May-14 A 100% 100% 0.00 DHMEP08120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 01-Jun-14 07-Jun-14 07-Jun-14 A 19-Jun-14 A 100% 100% 1.00 DHMEP08160 Pressure Testing of Pipes 12.00 08-Jun-14 21-Jun-14 17-May-14 A 21-Jul-14 A 100% 100% 0.00 DHMEP08110 MEP Works in Risers& Clearance 5.00 23-Jul-14 30-Jul-14 19-Apr-14 A 06-Oct-14 -33.00 100% 78% 0.00 DHMEP08140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es17-Sep-14 24-Sep-14 01-Jul-14 A 04-Nov-14 5.00 100% 68% 0.68 DHMEP08150 MEP Final Fixes 6.00 15-Apr-15 21-Apr-15 13-Jun-15 18-Jun-15 -41.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 9 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 54.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHMEP06190 Sanitary ware /Toilet accessories 6.00 19-Apr-15 25-Apr-15 16-Jun-15 22-Jun-15 -41.00 0% 0% 0.00 DHMEP08200 Pre-Testing & Commissioning 7.00 02-May-15 09-May-15 25-Jun-15 02-Jul-15 -43.00 0% 0% 0.00 LEVEL 09 431.00 17-Mar-14 18-Jun-15 12-Mar-14 A 13-Aug-15 -43.00 73.77% 69.13% 0.94 STRUCTURAL WORKS -LEVEL 09 19.00 17-Mar-14 07-Apr-14 12-Mar-14 A 08-Apr-14 A 100% 100% 1.00 DHCWA10100 Core Wall - Level 09 10.00 17-Mar-14 27-Mar-14 12-Mar-14 A 27-Mar-14 A 100% 100% 1.00 DHSLA09100 Construction of Horizontals - L09 4.00 31-Mar-14 03-Apr-14 25-Mar-14 A 03-Apr-14 A 100% 100% 1.00 DHCWA10110 Construction of Verticals - L09 3.00 05-Apr-14 07-Apr-14 03-Apr-14 A 08-Apr-14 A 100% 100% 1.00 STAIRCASES 4.00 14-Jun-14 17-Jun-14 19-Jun-14 A 23-Jun-14 A 0% 0% 0.00 A1360 Stair # 1 4.00 14-Jun-14 17-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00 A1370 Stair # 2 4.00 14-Jun-14 17-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 09 283.00 01-May-14 18-Jun-15 12-May-14 A 13-Aug-15 -43.00 37.84% 19.77% 0.52 Dry area 246.00 24-May-14 24-May-15 28-May-14 A 23-Jul-15 -37.00 38.95% 35.49% 0.91 DHFSH09100 Block Work in Dry Area 6.00 24-May-14 31-May-14 28-May-14 A 15-Jun-14 A 100% 100% 1.00 DHFSH09120 Marking,Cutting & Chasing - Dry Area 4.00 01-Jun-14 04-Jun-14 05-Jun-14 A 22-Jun-14 A 100% 100% 1.00 DHFSH09130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 05-Jun-14 09-Jun-14 05-Jul-14 A 15-Jul-14 A 100% 100% 1.00 DHFSH09160 Plaster in Dry Area 8.00 29-Jun-14 08-Jul-14 10-Jul-14 A 24-Aug-14 A 100% 100% 1.00 DHFSH09190 Dry Area Floor Screed 7.00 08-Jul-14 16-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00 DHFSH09230 Dry Area Painting - Primer 4.00 16-Jul-14 21-Jul-14 09-Sep-14 A 01-Oct-14 63.00 100% 80% 0.00 DHFSH09260 Dry Area Painting - Stucco 6.00 21-Jul-14 30-Jul-14 14-Sep-14 A 06-Oct-14 63.00 100% 60% 0.00 DHFSH09290 Dry Area False Ceiling Suspension 6.00 06-Sep-14 13-Sep-14 18-Oct-14 23-Oct-14 -8.00 100% 0% 0.00 DHFSH09350 Dry Area False Ceiling Tiling / Boarding 5.00 29-Sep-14 07-Oct-14 11-Nov-14 16-Nov-14 29.00 22.5% 0% 0.00 DHFSH09400 Dry Area Painting - 1st Coat 5.00 07-Oct-14 13-Oct-14 17-Nov-14 22-Nov-14 29.00 0% 0% 0.00 DHFSH09450 Dry Area Flooring 5.00 30-Oct-14 05-Nov-14 04-Dec-14 09-Dec-14 20.00 0% 0% 0.00 DHFSH09430 Installation of Timber Doors & Ironmongery 5.00 08-Apr-15 13-Apr-15 07-Jun-15 11-Jun-15 -50.00 0% 0% 0.00 DHFSH09802 Installation of Wardrobe 12.00 03-May-15 17-May-15 01-Jul-15 14-Jul-15 -50.00 0% 0% 0.00 DHFSH09500 Paint Final Coat 6.00 18-May-15 24-May-15 15-Jul-15 23-Jul-15 -37.00 0% 0% 0.00 Wet area 232.00 24-May-14 17-May-15 28-May-14 A 14-Jul-15 -50.00 35.69% 10.5% 0.29 DHFSH09110 Block Work in Wet Area 6.00 24-May-14 31-May-14 28-May-14 A 15-Jun-14 A 100% 100% 0.00 DHFSH09140 Marking,Cutting & Chasing - Wet Area 4.00 01-Jun-14 04-Jun-14 05-Jun-14 A 22-Jun-14 A 100% 100% 1.00 DHFSH09150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 05-Jun-14 09-Jun-14 05-Jul-14 A 15-Jul-14 A 100% 100% 1.00 DHFSH09170 Plaster in Wet Area 4.00 23-Jun-14 28-Jun-14 10-Jul-14 A 24-Aug-14 A 100% 100% 1.00 DHFSH09180 Wet Area Wall Tiling 6.00 06-Sep-14 13-Sep-14 13-Oct-14 19-Oct-14 1.00 100% 0% 0.00 DHFSH09300 Wet Area False Ceiling Suspension 5.00 13-Sep-14 18-Sep-14 26-Oct-14 30-Oct-14 5.00 100% 0% 0.00 DHFSH09370 Wet Area False Ceiling Tiling/Boarding 4.00 29-Sep-14 06-Oct-14 11-Nov-14 15-Nov-14 5.00 28.13% 0% 0.00 DHFSH09210 Wet Area Waterproofing 4.00 06-Oct-14 11-Oct-14 16-Nov-14 19-Nov-14 5.00 0% 0% 0.00 DHFSH09220 Wet Area Floor Screed 4.00 11-Oct-14 15-Oct-14 20-Nov-14 24-Nov-14 5.00 0% 0% 0.00 DHFSH09250 Wet Area Floor Tiling 5.00 15-Oct-14 21-Oct-14 25-Nov-14 30-Nov-14 5.00 0% 0% 0.00 DHFSH06530 Cabinet Carcass 5.00 05-Nov-14 10-Nov-14 04-Dec-14 09-Dec-14 3.00 0% 0% 0.00 DHFSH07020 Installation of Shower Enclosure 4.00 14-Apr-15 18-Apr-15 13-Jun-15 16-Jun-15 -39.00 0% 0% 0.00 DHFSH09390 Installation of Vanity Counters & Tops 5.00 14-Apr-15 19-Apr-15 13-Jun-15 17-Jun-15 -50.00 0% 0% 0.00 DHFSH09800 Installation of Kitchen Cabinet 12.00 03-May-15 17-May-15 01-Jul-15 14-Jul-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 87.00 16-Jul-14 21-Mar-15 01-Sep-14 A 23-Dec-14 118.00 37.44% 0% 0.00 DHFSH09240 Corridor/Lift Lobby Floor Screed 4.00 16-Jul-14 21-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00 DHFSH09270 Lift Lobby Painting - Primer & Stucco 6.00 21-Jul-14 30-Jul-14 09-Sep-14 A 02-Oct-14 26.00 100% 65% 0.00 DHFSH09310 Lift Lobby False Ceiling Suspension 6.00 18-Sep-14 25-Sep-14 01-Nov-14 06-Nov-14 5.00 100% 0% 0.00 DHFSH09360 Lift Lobby False Ceiling Tiling / Boarding 5.00 29-Sep-14 07-Oct-14 11-Nov-14 16-Nov-14 112.00 22.5% 0% 0.00 DHFSH09410 Lift Lobby Painting - 1st Coat 6.00 07-Oct-14 14-Oct-14 17-Nov-14 23-Nov-14 112.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - Level 09 Construction of Horizontals - L09 Construction of Verticals - L09 Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 10 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 55.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH09440 Installation of Steel Doors & Windows 3.00 18-Mar-15 21-Mar-15 10-Dec-14 13-Dec-14 83.00 0% 0% 0.00 DHFSH09470 Lift Lobby Flooring 6.00 05-Nov-14 12-Nov-14 10-Dec-14 16-Dec-14 118.00 0% 0% 0.00 DHFSH09490 Utility Rooms- Epoxy Flooring 6.00 12-Nov-14 19-Nov-14 17-Dec-14 23-Dec-14 118.00 0% 0% 0.00 Staircase 66.00 08-Jul-14 29-Mar-15 01-Oct-14 21-Dec-14 91.00 45.08% 0% 0.00 DHFSH09200 Staircase Plastering 4.00 08-Jul-14 13-Jul-14 01-Oct-14 07-Oct-14 130.00 100% 0% 0.00 DHFSH09280 Staircase Painting - Primer & Stucco 6.00 30-Jul-14 06-Aug-14 08-Oct-14 14-Oct-14 130.00 100% 0% 0.00 DHFSH09320 Staircase Handrail Fixing 3.00 15-Dec-14 18-Dec-14 27-Oct-14 29-Oct-14 125.00 0% 0% 0.00 DHFSH09330 Staircase Painting 1st Coat 3.00 18-Dec-14 22-Dec-14 23-Nov-14 25-Nov-14 105.00 0% 0% 0.00 DHFSH09340 Staircase Final Painting 5.00 22-Mar-15 26-Mar-15 14-Dec-14 18-Dec-14 91.00 0% 0% 0.00 DHFSH09380 Staircase Epoxy Flooring 2.00 28-Mar-15 29-Mar-15 20-Dec-14 21-Dec-14 91.00 0% 0% 0.00 General 270.00 01-May-14 18-Jun-15 12-May-14 A 13-Aug-15 -43.00 0% 0% 0.00 DHSTR09000 Access from Structure 0.00 01-May-14 12-May-14 A 100% 100% 0.00 DHFSH09510 Snagging & De-Snagging 12.00 06-Jun-15 18-Jun-15 01-Aug-15 13-Aug-15 -43.00 0% 0% 0.00 MEP - LEVEL 09 402.00 31-Mar-14 17-May-15 25-Mar-14 A 09-Jul-15 -43.00 71.82% 70.75% 0.99 DHMEP09000 Embeded Conduits & Boxex - Concrete Works 4.00 31-Mar-14 03-Apr-14 25-Mar-14 A 03-Apr-14 A 100% 100% 0.00 DHMEP09100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C03a-bMlianyg- ,1 4Wiring et2c2-May-14 12-May-14 A 14-Jun-14 A 100% 100% 1.00 DHMEP09130 Cable Trays & Cable Trunking 6.00 01-Jun-14 07-Jun-14 12-May-14 A 14-Jun-14 A 100% 100% 0.00 DHMEP09160 Pressure Testing of Pipes 12.00 12-Jun-14 25-Jun-14 07-Jun-14 A 27-Jul-14 A 100% 100% 0.00 DHMEP09120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 05-Jun-14 11-Jun-14 17-Jun-14 A 20-Aug-14 A 100% 100% 1.00 DHMEP09110 MEP Works in Risers& Clearance 5.00 27-Jul-14 03-Aug-14 12-May-14 A 09-Oct-14 -33.00 100% 78% 0.00 DHMEP09140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es22-Sep-14 29-Sep-14 29-Jul-14 A 10-Nov-14 5.00 100% 63% 0.63 DHMEP09150 MEP Final Fixes 6.00 20-Apr-15 26-Apr-15 18-Jun-15 24-Jun-15 -40.00 0% 0% 0.00 DHMEP06210 Sanitary ware /Toilet accessories 6.00 23-Apr-15 29-Apr-15 22-Jun-15 28-Jun-15 -40.00 0% 0% 0.00 DHMEP09200 Pre-Testing & Commissioning 7.00 09-May-15 17-May-15 02-Jul-15 09-Jul-15 -43.00 0% 0% 0.00 LEVEL 10 432.00 29-Mar-14 25-Jun-15 24-Feb-14 A 20-Aug-15 -43.00 72.28% 69.07% 0.96 STRUCTURAL WORKS -LEVEL 10 15.00 29-Mar-14 14-Apr-14 29-Mar-14 A 15-Apr-14 A 100% 100% 1.00 DHCWA11100 Core Wall - Level 10 4.00 29-Mar-14 01-Apr-14 29-Mar-14 A 06-Apr-14 A 100% 100% 1.00 DHSLA10100 Construction of Horizontals - L10 4.00 07-Apr-14 10-Apr-14 05-Apr-14 A 10-Apr-14 A 100% 100% 1.00 DHCWA11110 Construction of Verticals - L10 3.00 12-Apr-14 14-Apr-14 13-Apr-14 A 15-Apr-14 A 100% 100% 1.00 STAIRCASES 4.00 19-Jun-14 23-Jun-14 19-Jun-14 A 23-Jun-14 A 0% 0% 0.00 A1380 Stair # 1 4.00 19-Jun-14 23-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00 A1390 Stair # 2 4.00 19-Jun-14 23-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 10 276.00 07-May-14 25-Jun-15 24-Feb-14 A 20-Aug-15 -43.00 36.53% 19.64% 0.54 Dry area 252.00 01-Jun-14 31-May-15 24-Feb-14 A 30-Jul-15 -37.00 38.17% 35.49% 0.93 DHFSH10190 Dry Area Floor Screed 7.00 13-Jul-14 21-Jul-14 24-Feb-14 A 24-Feb-14 A 100% 100% 0.00 DHFSH10100 Block Work in Dry Area 6.00 01-Jun-14 07-Jun-14 02-Jun-14 A 17-Jun-14 A 100% 100% 1.00 DHFSH10120 Marking,Cutting & Chasing - Dry Area 4.00 08-Jun-14 11-Jun-14 15-Jun-14 A 24-Jun-14 A 100% 100% 1.00 DHFSH10130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 12-Jun-14 16-Jun-14 08-Jul-14 A 19-Jul-14 A 100% 100% 1.00 DHFSH10160 Plaster in Dry Area 8.00 03-Jul-14 13-Jul-14 13-Jul-14 A 25-Aug-14 A 100% 100% 1.00 DHFSH10230 Dry Area Painting - Primer 4.00 21-Jul-14 26-Jul-14 15-Sep-14 A 01-Oct-14 67.00 100% 80% 0.00 DHFSH10260 Dry Area Painting - Stucco 6.00 26-Jul-14 04-Aug-14 20-Sep-14 A 06-Oct-14 67.00 100% 60% 0.00 DHFSH10290 Dry Area False Ceiling Suspension 6.00 10-Sep-14 17-Sep-14 01-Nov-14 06-Nov-14 -15.00 100% 0% 0.00 DHFSH10350 Dry Area False Ceiling Tiling / Boarding / Boarding 5.00 04-Nov-14 09-Nov-14 24-Nov-14 29-Nov-14 22.00 0% 0% 0.00 DHFSH10400 Dry Area Painting - 1st Coat 6.00 10-Nov-14 16-Nov-14 30-Nov-14 07-Dec-14 22.00 0% 0% 0.00 DHFSH10450 Dry Area Flooring 5.00 24-Nov-14 29-Nov-14 15-Dec-14 20-Dec-14 16.00 0% 0% 0.00 DHFSH10430 Installation of Timber Doors & Ironmongery 5.00 14-Apr-15 19-Apr-15 13-Jun-15 17-Jun-15 -50.00 0% 0% 0.00 DHFSH10802 Installation of Wardrobe 12.00 10-May-15 24-May-15 08-Jul-15 23-Jul-15 -50.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Pressure Testing of Pipes Embeded Condiuts,Boxes and Sleeves in Walls MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - Level 10 Construction of Horizontals - L10 Construction of Verticals - L10 Stair # 1 Stair # 2 Dry Area Floor Screed Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 11 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 56.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH10500 Paint Final Coat 6.00 25-May-15 31-May-15 25-Jul-15 30-Jul-15 -37.00 0% 0% 0.00 Wet area 234.00 01-Jun-14 24-May-15 02-Jun-14 A 23-Jul-15 -50.00 34.32% 10.35% 0.30 DHFSH10110 Block Work in Wet Area 6.00 01-Jun-14 07-Jun-14 02-Jun-14 A 17-Jun-14 A 100% 100% 0.00 DHFSH10140 Marking,Cutting & Chasing - Wet Area 4.00 08-Jun-14 11-Jun-14 15-Jun-14 A 24-Jun-14 A 100% 100% 1.00 DHFSH10150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 12-Jun-14 16-Jun-14 08-Jul-14 A 19-Jul-14 A 100% 100% 1.00 DHFSH10170 Plaster in Wet Area 4.00 26-Jun-14 01-Jul-14 13-Jul-14 A 25-Aug-14 A 100% 100% 1.00 DHFSH10180 Wet Area Wall Tiling 6.00 10-Sep-14 17-Sep-14 18-Oct-14 23-Oct-14 1.00 100% 0% 0.00 DHFSH10300 Wet Area False Ceiling Suspension 5.00 17-Sep-14 23-Sep-14 08-Nov-14 12-Nov-14 -1.00 100% 0% 0.00 DHFSH10370 Wet Area False Ceiling Tiling/Boarding 4.00 04-Nov-14 08-Nov-14 24-Nov-14 27-Nov-14 -1.00 0% 0% 0.00 DHFSH10210 Wet Area Waterproofing 4.00 09-Nov-14 12-Nov-14 29-Nov-14 03-Dec-14 -1.00 0% 0% 0.00 DHFSH10220 Wet Area Floor Screed 4.00 13-Nov-14 17-Nov-14 04-Dec-14 08-Dec-14 -1.00 0% 0% 0.00 DHFSH10250 Wet Area Floor Tiling 5.00 18-Nov-14 23-Nov-14 09-Dec-14 14-Dec-14 -1.00 0% 0% 0.00 DHFSH06540 Cabinet Carcass 6.00 24-Nov-14 30-Nov-14 15-Dec-14 21-Dec-14 -1.00 0% 0% 0.00 DHFSH10390 Installation of Vanity Counters & Tops 5.00 20-Apr-15 25-Apr-15 18-Jun-15 23-Jun-15 -50.00 0% 0% 0.00 DHFSH10420 Installation of Shower Enclosure 4.00 26-Apr-15 29-Apr-15 24-Jun-15 28-Jun-15 -44.00 0% 0% 0.00 DHFSH10800 Installation of Kitchen Cabinet 12.00 10-May-15 24-May-15 08-Jul-15 23-Jul-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 77.00 21-Jul-14 24-Mar-15 01-Sep-14 A 04-Jan-15 111.00 28.95% 0% 0.00 DHFSH10240 Corridor/Lift Lobby Floor Screed 4.00 21-Jul-14 26-Jul-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00 DHFSH10270 Lift Lobby Painting - Primer & Stucco 6.00 26-Jul-14 04-Aug-14 15-Sep-14 A 06-Oct-14 30.00 100% 55% 0.00 DHFSH10310 Lift Lobby False Ceiling Suspension 6.00 23-Sep-14 30-Sep-14 13-Nov-14 19-Nov-14 -1.00 100% 0% 0.00 DHFSH10360 Lift Lobby False Ceiling Tiling / Boarding 5.00 04-Nov-14 09-Nov-14 24-Nov-14 29-Nov-14 104.00 0% 0% 0.00 DHFSH10410 Lift Lobby Painting - 1st Coat 6.00 10-Nov-14 16-Nov-14 30-Nov-14 07-Dec-14 104.00 0% 0% 0.00 DHFSH10440 Installation of Steel Doors & Windows 3.00 22-Mar-15 24-Mar-15 22-Dec-14 24-Dec-14 76.00 0% 0% 0.00 DHFSH10470 Lift Lobby Flooring 6.00 30-Nov-14 07-Dec-14 21-Dec-14 27-Dec-14 111.00 0% 0% 0.00 DHFSH10490 Utility Rooms- Epoxy Flooring 6.00 08-Dec-14 14-Dec-14 28-Dec-14 04-Jan-15 111.00 0% 0% 0.00 Staircase 76.00 13-Jul-14 01-Apr-15 01-Oct-14 03-Jan-15 86.00 45.08% 0% 0.00 DHFSH10200 Staircase Plastering 4.00 13-Jul-14 17-Jul-14 01-Oct-14 07-Oct-14 133.00 100% 0% 0.00 DHFSH10280 Staircase Painting - Primer & Stucco 6.00 04-Aug-14 11-Aug-14 08-Oct-14 14-Oct-14 133.00 100% 0% 0.00 DHFSH10320 Staircase Handrail Fixing 3.00 18-Dec-14 22-Dec-14 30-Oct-14 02-Nov-14 127.00 0% 0% 0.00 DHFSH10330 Staircase Painting 1st Coat 3.00 22-Dec-14 25-Dec-14 08-Dec-14 10-Dec-14 98.00 0% 0% 0.00 DHFSH10340 Staircase Final Painting 5.00 25-Mar-15 30-Mar-15 25-Dec-14 30-Dec-14 86.00 0% 0% 0.00 DHFSH10380 Staircase Epoxy Flooring 2.00 31-Mar-15 01-Apr-15 31-Dec-14 03-Jan-15 86.00 0% 0% 0.00 General 276.00 07-May-14 25-Jun-15 17-May-14 A 20-Aug-15 -43.00 0% 0% 0.00 DHSTR10000 Access from Structure 0.00 07-May-14 17-May-14 A 100% 100% 0.00 DHFSH10510 Snagging & De-Snagging 12.00 13-Jun-15 25-Jun-15 08-Aug-15 20-Aug-15 -43.00 0% 0% 0.00 MEP - LEVEL 10 404.00 07-Apr-14 23-May-15 05-Apr-14 A 16-Jul-15 -44.00 69.07% 70.81% 1.03 DHMEP10000 Embeded Conduits & Boxex - Concrete Works 4.00 07-Apr-14 10-Apr-14 05-Apr-14 A 10-Apr-14 A 100% 100% 0.00 DHMEP10100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C08a-bMlianyg- ,1 4Wiring et2c9-May-14 19-May-14 A 19-Jun-14 A 100% 100% 1.00 DHMEP10130 Cable Trays & Cable Trunking 6.00 08-Jun-14 14-Jun-14 19-May-14 A 19-Jun-14 A 100% 100% 0.00 DHMEP10160 Pressure Testing of Pipes 12.00 19-Jun-14 02-Jul-14 09-Jun-14 A 30-Jul-14 A 100% 100% 0.00 DHMEP10120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 12-Jun-14 18-Jun-14 24-Jun-14 A 24-Aug-14 A 100% 100% 1.00 DHMEP10110 MEP Works in Risers& Clearance 5.00 04-Aug-14 09-Aug-14 17-May-14 A 11-Oct-14 -33.00 100% 78% 0.00 DHMEP10140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es28-Oct-14 03-Nov-14 02-Aug-14 A 23-Nov-14 -1.00 0% 60% 0.00 DHMEP10150 MEP Final Fixes 6.00 30-Apr-15 06-May-15 29-Jun-15 05-Jul-15 -44.00 0% 0% 0.00 DHMEP06220 Sanitary ware /Toilet accessories 6.00 04-May-15 10-May-15 02-Jul-15 08-Jul-15 -44.00 0% 0% 0.00 DHMEP10200 Pre-Testing & Commissioning 7.00 14-May-15 23-May-15 09-Jul-15 16-Jul-15 -44.00 0% 0% 0.00 LEVEL 11 480.00 02-Apr-14 02-Jul-15 24-Feb-14 A 28-Sep-15 -68.00 72.14% 68.82% 0.95 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Vanity Counters & Tops Installation of Shower Enclosure Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Pressure Testing of Pipes Embeded Condiuts,Boxes and Sleeves in Walls MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 12 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 57.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 STRUCTURAL WORKS -LEVEL 11 16.00 02-Apr-14 20-Apr-14 07-Apr-14 A 21-Apr-14 A 100% 100% 1.00 DHCWA12100 Core Wall - Level 11 4.00 02-Apr-14 06-Apr-14 07-Apr-14 A 08-Apr-14 A 100% 100% 1.00 DHSLA11100 Construction of Horizontals - L11 4.00 14-Apr-14 17-Apr-14 12-Apr-14 A 17-Apr-14 A 100% 100% 1.00 DHCWA12110 Construction of Verticals - L11 2.00 19-Apr-14 20-Apr-14 18-Apr-14 A 21-Apr-14 A 100% 100% 1.00 STAIRCASES 4.00 25-Jun-14 29-Jun-14 19-Jun-14 A 23-Jun-14 A 0% 0% 0.00 A1400 Stair # 1 4.00 25-Jun-14 29-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00 A1410 Stair # 2 4.00 25-Jun-14 29-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 11 282.00 13-May-14 02-Jul-15 24-Feb-14 A 27-Aug-15 -43.00 35.81% 19.64% 0.55 Dry area 258.00 05-Jun-14 07-Jun-15 24-Feb-14 A 06-Aug-15 -37.00 38.17% 35.49% 0.93 DHFSH11190 Dry Area Floor Screed 7.00 17-Jul-14 26-Jul-14 24-Feb-14 A 24-Feb-14 A 100% 100% 0.00 DHFSH11100 Block Work in Dry Area 6.00 05-Jun-14 11-Jun-14 14-Jun-14 A 23-Jun-14 A 100% 100% 1.00 DHFSH11120 Marking,Cutting & Chasing - Dry Area 4.00 12-Jun-14 16-Jun-14 30-Jun-14 A 05-Jul-14 A 100% 100% 1.00 DHFSH11130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 17-Jun-14 21-Jun-14 09-Jul-14 A 13-Jul-14 A 100% 100% 1.00 DHFSH11160 Plaster in Dry Area 8.00 08-Jul-14 17-Jul-14 02-Aug-14 A 25-Aug-14 A 100% 100% 1.00 DHFSH11230 Dry Area Painting - Primer 4.00 26-Jul-14 02-Aug-14 18-Sep-14 A 01-Oct-14 71.00 100% 80% 0.00 DHFSH11260 Dry Area Painting - Stucco 6.00 02-Aug-14 09-Aug-14 23-Sep-14 A 08-Oct-14 71.00 100% 40% 0.00 DHFSH11290 Dry Area False Ceiling Suspension 7.00 14-Sep-14 22-Sep-14 04-Nov-14 11-Nov-14 -15.00 100% 0% 0.00 DHFSH11350 Dry Area False Ceiling Tiling / Boarding 5.00 08-Nov-14 12-Nov-14 29-Nov-14 04-Dec-14 24.00 0% 0% 0.00 DHFSH11400 Dry Area Painting - 1st Coat 5.00 13-Nov-14 18-Nov-14 06-Dec-14 10-Dec-14 24.00 0% 0% 0.00 DHFSH11450 Dry Area Flooring 5.00 30-Nov-14 06-Dec-14 21-Dec-14 25-Dec-14 16.00 0% 0% 0.00 DHFSH11430 Installation of Timber Doors & Ironmongery 5.00 19-Apr-15 23-Apr-15 17-Jun-15 22-Jun-15 -50.00 0% 0% 0.00 DHFSH11802 Installation of Wardrobe 12.00 18-May-15 31-May-15 15-Jul-15 30-Jul-15 -50.00 0% 0% 0.00 DHFSH11500 Paint Final Coat 6.00 01-Jun-15 07-Jun-15 01-Aug-15 06-Aug-15 -37.00 0% 0% 0.00 Wet area 236.00 05-Jun-14 31-May-15 14-Jun-14 A 30-Jul-15 -50.00 34.32% 10.35% 0.30 DHFSH11110 Block Work in Wet Area 6.00 05-Jun-14 11-Jun-14 14-Jun-14 A 23-Jun-14 A 100% 100% 0.00 DHFSH11140 Marking,Cutting & Chasing - Wet Area 4.00 12-Jun-14 16-Jun-14 30-Jun-14 A 05-Jul-14 A 100% 100% 1.00 DHFSH11150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 17-Jun-14 21-Jun-14 09-Jul-14 A 13-Jul-14 A 100% 100% 1.00 DHFSH11170 Plaster in Wet Area 4.00 30-Jun-14 05-Jul-14 02-Aug-14 A 25-Aug-14 A 100% 100% 1.00 DHFSH11180 Wet Area Wall Tiling 6.00 15-Sep-14 22-Sep-14 22-Oct-14 29-Oct-14 1.00 100% 0% 0.00 DHFSH11300 Wet Area False Ceiling Suspension 5.00 22-Sep-14 28-Sep-14 12-Nov-14 17-Nov-14 1.00 100% 0% 0.00 DHFSH11370 Wet Area False Ceiling Tiling/Boarding 4.00 08-Nov-14 11-Nov-14 29-Nov-14 03-Dec-14 1.00 0% 0% 0.00 DHFSH11210 Wet Area Waterproofing 4.00 12-Nov-14 16-Nov-14 04-Dec-14 08-Dec-14 1.00 0% 0% 0.00 DHFSH11220 Wet Area Floor Screed 4.00 17-Nov-14 20-Nov-14 09-Dec-14 13-Dec-14 1.00 0% 0% 0.00 DHFSH11250 Wet Area Floor Tiling 5.00 22-Nov-14 26-Nov-14 14-Dec-14 18-Dec-14 1.00 0% 0% 0.00 DHFSH06550 Cabinet Carcass 5.00 01-Dec-14 07-Dec-14 22-Dec-14 27-Dec-14 -1.00 0% 0% 0.00 DHFSH11390 Installation of Vanity Counters & Tops 5.00 26-Apr-15 30-Apr-15 24-Jun-15 29-Jun-15 -50.00 0% 0% 0.00 DHFSH11420 Installation of Shower Enclosure 4.00 29-Apr-15 03-May-15 28-Jun-15 01-Jul-15 -41.00 0% 0% 0.00 DHFSH11800 Installation of Kitchen Cabinet 12.00 18-May-15 31-May-15 15-Jul-15 30-Jul-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 82.00 26-Jul-14 28-Mar-15 01-Sep-14 A 10-Jan-15 108.00 10.25% 0% 0.00 DHFSH11240 Corridor/Lift Lobby Floor Screed 4.00 26-Jul-14 02-Aug-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00 DHFSH11270 Lift Lobby Painting - Primer & Stucco 6.00 02-Aug-14 09-Aug-14 18-Sep-14 A 06-Oct-14 36.00 100% 50% 0.00 DHFSH11310 Lift Lobby False Ceiling Suspension 6.00 28-Sep-14 07-Oct-14 18-Nov-14 24-Nov-14 1.00 35.42% 0% 0.00 DHFSH11360 Lift Lobby False Ceiling Tiling / Boarding 5.00 08-Nov-14 12-Nov-14 29-Nov-14 04-Dec-14 103.00 0% 0% 0.00 DHFSH11410 Lift Lobby Painting - 1st Coat 6.00 13-Nov-14 19-Nov-14 06-Dec-14 11-Dec-14 103.00 0% 0% 0.00 DHFSH11440 Installation of Steel Doors & Windows 3.00 25-Mar-15 28-Mar-15 28-Dec-14 30-Dec-14 74.00 0% 0% 0.00 DHFSH11470 Lift Lobby Flooring 6.00 07-Dec-14 13-Dec-14 27-Dec-14 03-Jan-15 108.00 0% 0% 0.00 DHFSH11490 Utility Rooms- Epoxy Flooring 6.00 14-Dec-14 20-Dec-14 04-Jan-15 10-Jan-15 108.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Core Wall - Level 11 Construction of Horizontals - L11 Construction of Verticals - L11 Stair # 1 Stair # 2 Dry Area Floor Screed Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Vanity Counters & Tops Installation of Shower Enclosure Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 13 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 58.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 Staircase 81.00 17-Jul-14 05-Apr-15 01-Oct-14 08-Jan-15 85.00 45.08% 0% 0.00 DHFSH11200 Staircase Plastering 4.00 17-Jul-14 22-Jul-14 01-Oct-14 07-Oct-14 136.00 100% 0% 0.00 DHFSH11280 Staircase Painting - Primer & Stucco 6.00 09-Aug-14 16-Aug-14 08-Oct-14 14-Oct-14 136.00 100% 0% 0.00 DHFSH11320 Staircase Handrail Fixing 3.00 22-Dec-14 25-Dec-14 03-Nov-14 05-Nov-14 128.00 0% 0% 0.00 DHFSH11330 Staircase Painting 1st Coat 3.00 25-Dec-14 29-Dec-14 11-Dec-14 14-Dec-14 99.00 0% 0% 0.00 DHFSH11340 Staircase Final Painting 5.00 29-Mar-15 02-Apr-15 31-Dec-14 06-Jan-15 85.00 0% 0% 0.00 DHFSH11380 Staircase Epoxy Flooring 2.00 04-Apr-15 05-Apr-15 07-Jan-15 08-Jan-15 85.00 0% 0% 0.00 General 282.00 13-May-14 02-Jul-15 24-May-14 A 27-Aug-15 -43.00 0% 0% 0.00 DHSTR11000 Access from Structure 0.00 13-May-14 24-May-14 A 100% 100% 0.00 DHFSH11510 Snagging & De-Snagging 12.00 20-Jun-15 02-Jul-15 15-Aug-15 27-Aug-15 -43.00 0% 0% 0.00 MEP - LEVEL 11 480.00 15-Apr-14 30-May-15 12-Apr-14 A 28-Sep-15 -97.00 69.07% 70.11% 1.02 DHMEP11000 Embeded Conduits & Boxex - Concrete Works 3.00 15-Apr-14 17-Apr-14 12-Apr-14 A 17-Apr-14 A 100% 100% 0.00 DHMEP11100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C14a-bMlianyg- ,1 4Wiring et0c4-Jun-14 26-May-14 A 30-Jun-14 A 100% 100% 1.00 DHMEP11130 Cable Trays & Cable Trunking 6.00 12-Jun-14 18-Jun-14 26-May-14 A 30-Jun-14 A 100% 100% 0.00 DHMEP11160 Pressure Testing of Pipes 12.00 24-Jun-14 07-Jul-14 30-Jul-14 A 26-Aug-14 A 100% 100% 0.00 DHMEP11120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 17-Jun-14 23-Jun-14 05-Jul-14 A 30-Aug-14 A 100% 100% 1.00 DHMEP11110 MEP Works in Risers& Clearance 5.00 09-Aug-14 13-Aug-14 24-May-14 A 15-Oct-14 -33.00 100% 76% 0.00 DHMEP11140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es01-Nov-14 06-Nov-14 04-Aug-14 A 27-Nov-14 1.00 0% 36% 0.00 DHMEP11150 MEP Final Fixes 6.00 07-May-15 13-May-15 06-Jul-15 12-Jul-15 -44.00 0% 0% 0.00 DHMEP06230 Sanitary ware /Toilet accessories 6.00 11-May-15 18-May-15 09-Jul-15 15-Jul-15 -44.00 0% 0% 0.00 DHMEP11200 Pre-Testing & Commissioning 7.00 23-May-15 30-May-15 16-Jul-15 26-Jul-15 -44.00 0% 0% 0.00 DHMEP11010 Busbar - L11to L15 20.00 12-Mar-15 04-Apr-15 03-Sep-15 28-Sep-15 -144.00 0% 0% 0.00 LEVEL 12 457.00 07-Apr-14 09-Jul-15 24-Feb-14 A 03-Sep-15 -43.00 71.98% 68.79% 0.96 STRUCTURAL WORKS -LEVEL 12 144.00 07-Apr-14 27-Apr-14 06-Apr-14 A 28-Apr-14 A 100% 100% 1.00 DHCWA13120 Tower Crane Jump 1.00 13-Apr-14 13-Apr-14 06-Apr-14 A 06-Apr-14 A 100% 100% 0.00 DHCWA13100 Core Wall - Level 12 6.00 07-Apr-14 13-Apr-14 10-Apr-14 A 14-Apr-14 A 100% 100% 1.00 DHSLA12100 Construction of Horizontals - L12 4.00 21-Apr-14 24-Apr-14 19-Apr-14 A 24-Apr-14 A 100% 100% 1.00 DHCWA13110 Construction of Verticals - L12 2.00 26-Apr-14 27-Apr-14 25-Apr-14 A 28-Apr-14 A 100% 100% 1.00 STAIRCASES 4.00 03-Jul-14 07-Jul-14 19-Jun-14 A 23-Jun-14 A 0% 0% 0.00 A1420 Stair # 1 4.00 03-Jul-14 07-Jul-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00 A1430 Stair # 2 3.00 05-Jul-14 07-Jul-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 12 288.00 19-May-14 09-Jul-15 24-Feb-14 A 03-Sep-15 -43.00 35% 19.64% 0.56 Dry area 264.00 11-Jun-14 14-Jun-15 24-Feb-14 A 13-Aug-15 -37.00 38.17% 35.49% 0.93 DHFSH12190 Dry Area Floor Screed 7.00 22-Jul-14 02-Aug-14 24-Feb-14 A 24-Feb-14 A 100% 100% 0.00 DHFSH12100 Block Work in Dry Area 6.00 11-Jun-14 17-Jun-14 09-Jun-14 A 02-Jul-14 A 100% 100% 1.00 DHFSH12130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 23-Jun-14 26-Jun-14 13-Jul-14 A 17-Jul-14 A 100% 100% 1.00 DHFSH12120 Marking,Cutting & Chasing - Dry Area 4.00 18-Jun-14 22-Jun-14 06-Jul-14 A 04-Aug-14 A 100% 100% 1.00 DHFSH12160 Plaster in Dry Area 8.00 13-Jul-14 22-Jul-14 06-Aug-14 A 28-Aug-14 A 100% 100% 1.00 DHFSH12230 Dry Area Painting - Primer 4.00 02-Aug-14 06-Aug-14 23-Sep-14 A 02-Oct-14 75.00 100% 60% 0.00 DHFSH12260 Dry Area Painting - Stucco 6.00 06-Aug-14 13-Aug-14 28-Sep-14 A 09-Oct-14 75.00 100% 40% 0.00 DHFSH12290 Dry Area False Ceiling Suspension 7.00 18-Sep-14 27-Sep-14 09-Nov-14 16-Nov-14 -15.00 100% 0% 0.00 DHFSH12350 Dry Area False Ceiling Tiling / Boarding 5.00 11-Nov-14 16-Nov-14 04-Dec-14 09-Dec-14 25.00 0% 0% 0.00 DHFSH12400 Dry Area Painting - 1st Coat 5.00 17-Nov-14 22-Nov-14 10-Dec-14 15-Dec-14 25.00 0% 0% 0.00 DHFSH12450 Dry Area Flooring 5.00 07-Dec-14 11-Dec-14 27-Dec-14 31-Dec-14 16.00 0% 0% 0.00 DHFSH12430 Installation of Timber Doors & Ironmongery 5.00 23-Apr-15 28-Apr-15 22-Jun-15 27-Jun-15 -50.00 0% 0% 0.00 DHFSH12802 Installation of Wardrobe 12.00 23-May-15 04-Jun-15 22-Jul-15 04-Aug-15 -50.00 0% 0% 0.00 DHFSH12500 Paint Final Coat 6.00 08-Jun-15 14-Jun-15 08-Aug-15 13-Aug-15 -37.00 0% 0% 0.00 Wet area 238.00 11-Jun-14 07-Jun-15 09-Jun-14 A 06-Aug-15 -50.00 33.43% 10.35% 0.31 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Pressure Testing of Pipes Embeded Condiuts,Boxes and Sleeves in Walls MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Busbar - L11to L15 Tower Crane Jump Core Wall - Level 12 Construction of Horizontals - L12 Construction of Verticals - L12 Stair # 1 Stair # 2 Dry Area Floor Screed Block Work in Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Marking,Cutting & Chasing - Dry Area Plaster in Dry Area Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 14 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 59.
    Activity ID ActivityName Original Duration DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH12110 Block Work in Wet Area 6.00 11-Jun-14 17-Jun-14 09-Jun-14 A 02-Jul-14 A 100% 100% 0.00 DHFSH12150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 23-Jun-14 26-Jun-14 13-Jul-14 A 17-Jul-14 A 100% 100% 1.00 DHFSH12140 Marking,Cutting & Chasing - Wet Area 4.00 18-Jun-14 22-Jun-14 06-Jul-14 A 04-Aug-14 A 100% 100% 1.00 DHFSH12170 Plaster in Wet Area 4.00 03-Jul-14 08-Jul-14 06-Aug-14 A 28-Aug-14 A 100% 100% 1.00 DHFSH12180 Wet Area Wall Tiling 6.00 20-Sep-14 27-Sep-14 28-Oct-14 03-Nov-14 1.00 100% 0% 0.00 DHFSH12300 Wet Area False Ceiling Suspension 5.00 27-Sep-14 02-Oct-14 17-Nov-14 22-Nov-14 2.00 62.5% 0% 0.00 DHFSH12370 Wet Area False Ceiling Tiling/Boarding 4.00 11-Nov-14 15-Nov-14 04-Dec-14 08-Dec-14 2.00 0% 0% 0.00 DHFSH12210 Wet Area Waterproofing 4.00 16-Nov-14 19-Nov-14 09-Dec-14 13-Dec-14 2.00 0% 0% 0.00 DHFSH12220 Wet Area Floor Screed 4.00 20-Nov-14 24-Nov-14 14-Dec-14 17-Dec-14 2.00 0% 0% 0.00 DHFSH12250 Wet Area Floor Tiling 5.00 25-Nov-14 30-Nov-14 18-Dec-14 23-Dec-14 2.00 0% 0% 0.00 DHFSH06560 Cabinet Carcass 6.00 08-Dec-14 14-Dec-14 28-Dec-14 04-Jan-15 -1.00 0% 0% 0.00 DHFSH12390 Installation of Vanity Counters & Tops 5.00 02-May-15 06-May-15 30-Jun-15 05-Jul-15 -50.00 0% 0% 0.00 DHFSH12420 Installation of Shower Enclosure 4.00 03-May-15 06-May-15 01-Jul-15 05-Jul-15 -40.00 0% 0% 0.00 DHFSH12800 Installation of Kitchen Cabinet 12.00 25-May-15 07-Jun-15 25-Jul-15 06-Aug-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 87.00 02-Aug-14 31-Mar-15 01-Sep-14 A 15-Jan-15 105.00 0% 0% 0.00 DHFSH12240 Corridor/Lift Lobby Floor Screed 4.00 02-Aug-14 06-Aug-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00 DHFSH12270 Lift Lobby Painting - Primer & Stucco 6.00 06-Aug-14 13-Aug-14 23-Sep-14 A 07-Oct-14 40.00 100% 35% 0.00 DHFSH12310 Lift Lobby False Ceiling Suspension 6.00 02-Oct-14 12-Oct-14 23-Nov-14 29-Nov-14 2.00 0% 0% 0.00 DHFSH12360 Lift Lobby False Ceiling Tiling / Boarding 5.00 11-Nov-14 16-Nov-14 04-Dec-14 09-Dec-14 102.00 0% 0% 0.00 DHFSH12410 Lift Lobby Painting - 1st Coat 6.00 17-Nov-14 23-Nov-14 10-Dec-14 16-Dec-14 102.00 0% 0% 0.00 DHFSH12440 Installation of Steel Doors & Windows 3.00 29-Mar-15 31-Mar-15 05-Jan-15 07-Jan-15 71.00 0% 0% 0.00 DHFSH12470 Lift Lobby Flooring 6.00 13-Dec-14 18-Dec-14 03-Jan-15 08-Jan-15 105.00 0% 0% 0.00 DHFSH12490 Utility Rooms- Epoxy Flooring 6.00 20-Dec-14 25-Dec-14 10-Jan-15 15-Jan-15 105.00 0% 0% 0.00 Staircase 87.00 22-Jul-14 08-Apr-15 01-Oct-14 15-Jan-15 83.00 45.08% 0% 0.00 DHFSH12200 Staircase Plastering 4.00 22-Jul-14 27-Jul-14 01-Oct-14 07-Oct-14 139.00 100% 0% 0.00 DHFSH12280 Staircase Painting - Primer & Stucco 6.00 13-Aug-14 20-Aug-14 08-Oct-14 14-Oct-14 139.00 100% 0% 0.00 DHFSH12320 Staircase Handrail Fixing 3.00 25-Dec-14 29-Dec-14 06-Nov-14 09-Nov-14 129.00 0% 0% 0.00 DHFSH12330 Staircase Painting 1st Coat 3.00 29-Dec-14 03-Jan-15 16-Dec-14 18-Dec-14 99.00 0% 0% 0.00 DHFSH12340 Staircase Final Painting 5.00 01-Apr-15 06-Apr-15 08-Jan-15 13-Jan-15 83.00 0% 0% 0.00 DHFSH12380 Staircase Epoxy Flooring 2.00 07-Apr-15 08-Apr-15 14-Jan-15 15-Jan-15 83.00 0% 0% 0.00 General 288.00 19-May-14 09-Jul-15 03-Jun-14 A 03-Sep-15 -43.00 0% 0% 0.00 DHSTR12000 Access from Structure 0.00 19-May-14 03-Jun-14 A 100% 100% 0.00 DHFSH12510 Snagging & De-Snagging 12.00 27-Jun-15 09-Jul-15 22-Aug-15 03-Sep-15 -43.00 0% 0% 0.00 MEP - LEVEL 12 427.00 22-Apr-14 03-Jun-15 19-Apr-14 A 30-Jul-15 -44.00 69.07% 69.97% 1.01 DHMEP12000 Embeded Conduits & Boxex - Concrete Works 3.00 22-Apr-14 24-Apr-14 19-Apr-14 A 24-Apr-14 A 100% 100% 0.00 DHMEP12100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C20a-bMlianyg- ,1 4Wiring et1c0-Jun-14 03-Jun-14 A 22-Jul-14 A 100% 100% 1.00 DHMEP12130 Cable Trays & Cable Trunking 6.00 18-Jun-14 24-Jun-14 03-Jun-14 A 22-Jul-14 A 100% 100% 0.00 DHMEP12120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 23-Jun-14 29-Jun-14 09-Jul-14 A 02-Sep-14 A 100% 100% 1.00 DHMEP12160 Pressure Testing of Pipes 12.00 30-Jun-14 13-Jul-14 30-Jul-14 A 02-Oct-14 47.00 100% 83% 0.00 DHMEP12110 MEP Works in Risers& Clearance 5.00 14-Aug-14 19-Aug-14 03-Jun-14 A 16-Oct-14 -33.00 100% 69% 0.00 DHMEP12140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es04-Nov-14 10-Nov-14 10-Aug-14 A 03-Dec-14 2.00 0% 31% 0.00 DHMEP12150 MEP Final Fixes 6.00 12-May-15 19-May-15 11-Jul-15 16-Jul-15 -44.00 0% 0% 0.00 DHMEP06240 Sanitary ware /Toilet accessories 6.00 17-May-15 23-May-15 14-Jul-15 22-Jul-15 -44.00 0% 0% 0.00 DHMEP12200 Pre-Testing & Commissioning 7.00 27-May-15 03-Jun-15 23-Jul-15 30-Jul-15 -44.00 0% 0% 0.00 LEVEL 13 459.00 14-Apr-14 15-Jul-15 24-Feb-14 A 09-Sep-15 -43.00 71.49% 68.83% 0.96 STRUCTURAL WORKS -LEVEL 13 17.00 14-Apr-14 03-May-14 15-Apr-14 A 05-May-14 A 100% 100% 1.00 DHCWA14100 Core Wall - Level 13 4.00 14-Apr-14 17-Apr-14 15-Apr-14 A 20-Apr-14 A 100% 100% 1.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Block Work in Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Marking,Cutting & Chasing - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Vanity Counters & Tops Installation of Shower Enclosure Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - Level 13 Data Date : 30-Sep-14 Page : 15 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 60.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHSLA13100 Construction of Horizontals - L13 3.00 28-Apr-14 30-Apr-14 25-Apr-14 A 01-May-14 A 100% 100% 1.00 DHCWA14110 Construction of Verticals - L13 2.00 01-May-14 03-May-14 02-May-14 A 05-May-14 A 100% 100% 1.00 STAIRCASES 4.00 12-Jul-14 15-Jul-14 19-Jun-14 A 14-Jul-14 A 0% 0% 0.00 A1450 Stair # 2 3.00 13-Jul-14 15-Jul-14 19-Jun-14 A 23-Jun-14 A 100% 100% 0.00 A1440 Stair # 1 4.00 12-Jul-14 15-Jul-14 23-Jun-14 A 14-Jul-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 13 293.00 25-May-14 15-Jul-15 24-Feb-14 A 09-Sep-15 -43.00 32.69% 19.64% 0.60 Dry area 270.00 17-Jun-14 21-Jun-15 24-Feb-14 A 20-Aug-15 -38.00 37.83% 35.49% 0.94 DHMEP13190 Dry Area Floor Screed 7.00 27-Jul-14 06-Aug-14 24-Feb-14 A 24-Feb-14 A 100% 100% 0.00 DHFSH13100 Block Work in Dry Area 6.00 17-Jun-14 23-Jun-14 17-Jun-14 A 09-Jul-14 A 100% 100% 1.00 DHFSH13120 Marking,Cutting & Chasing - Dry Area 4.00 24-Jun-14 28-Jun-14 10-Jul-14 A 06-Aug-14 A 100% 100% 1.00 DHFSH13130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 29-Jun-14 02-Jul-14 14-Jul-14 A 07-Aug-14 A 100% 100% 1.00 DHFSH13160 Plaster in Dry Area 8.00 17-Jul-14 27-Jul-14 11-Aug-14 A 28-Aug-14 A 100% 100% 1.00 DHFSH13230 Dry Area Painting - Primer 4.00 06-Aug-14 11-Aug-14 25-Sep-14 A 02-Oct-14 79.00 100% 50% 0.00 DHFSH13260 Dry Area Painting - Stucco 6.00 11-Aug-14 18-Aug-14 29-Sep-14 A 11-Oct-14 79.00 100% 20% 0.00 DHFSH13290 Dry Area False Ceiling Suspension 7.00 23-Sep-14 01-Oct-14 13-Nov-14 20-Nov-14 -15.00 87.5% 0% 0.00 DHFSH13350 Dry Area False Ceiling Tiling / Boarding 5.00 15-Nov-14 19-Nov-14 09-Dec-14 14-Dec-14 26.00 0% 0% 0.00 DHFSH13400 Dry Area Painting - 1st Coat 5.00 20-Nov-14 25-Nov-14 15-Dec-14 20-Dec-14 26.00 0% 0% 0.00 DHFSH13450 Dry Area Flooring 5.00 13-Dec-14 17-Dec-14 03-Jan-15 07-Jan-15 16.00 0% 0% 0.00 DHFSH13430 Installation of Timber Doors & Ironmongery 6.00 29-Apr-15 05-May-15 28-Jun-15 04-Jul-15 -50.00 0% 0% 0.00 DHFSH13802 Installation of Wardrobe 12.00 27-May-15 09-Jun-15 27-Jul-15 09-Aug-15 -50.00 0% 0% 0.00 DHFSH13500 Paint Final Coat 6.00 15-Jun-15 21-Jun-15 15-Aug-15 20-Aug-15 -38.00 0% 0% 0.00 Wet area 240.00 17-Jun-14 14-Jun-15 17-Jun-14 A 13-Aug-15 -50.00 28.8% 10.35% 0.36 DHFSH13110 Block Work in Wet Area 6.00 17-Jun-14 23-Jun-14 17-Jun-14 A 09-Jul-14 A 100% 100% 0.00 DHFSH13140 Marking,Cutting & Chasing - Wet Area 4.00 24-Jun-14 28-Jun-14 10-Jul-14 A 06-Aug-14 A 100% 100% 1.00 DHFSH13150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 29-Jun-14 02-Jul-14 14-Jul-14 A 07-Aug-14 A 100% 100% 1.00 DHMEP13170 Plaster in Wet Area 4.00 07-Jul-14 12-Jul-14 11-Aug-14 A 28-Aug-14 A 100% 100% 1.00 DHMEP13180 Wet Area Wall Tiling 6.00 24-Sep-14 01-Oct-14 02-Nov-14 08-Nov-14 1.00 85.42% 0% 0.00 DHFSH13300 Wet Area False Ceiling Suspension 5.00 01-Oct-14 09-Oct-14 22-Nov-14 26-Nov-14 4.00 0% 0% 0.00 DHFSH13370 Wet Area False Ceiling Tiling/Boarding 4.00 15-Nov-14 18-Nov-14 09-Dec-14 13-Dec-14 4.00 0% 0% 0.00 DHFSH13210 Wet Area Waterproofing 4.00 19-Nov-14 23-Nov-14 14-Dec-14 17-Dec-14 4.00 0% 0% 0.00 DHFSH13220 Wet Area Floor Screed 4.00 24-Nov-14 27-Nov-14 18-Dec-14 22-Dec-14 4.00 0% 0% 0.00 DHFSH13250 Wet Area Floor Tiling 5.00 29-Nov-14 04-Dec-14 23-Dec-14 28-Dec-14 4.00 0% 0% 0.00 DHFSH06570 Cabinet Carcass 5.00 15-Dec-14 20-Dec-14 05-Jan-15 10-Jan-15 -1.00 0% 0% 0.00 DHFSH13420 Installation of Shower Enclosure 4.00 06-May-15 10-May-15 05-Jul-15 08-Jul-15 -39.00 0% 0% 0.00 DHFSH13390 Installation of Vanity Counters & Tops 5.00 06-May-15 11-May-15 05-Jul-15 09-Jul-15 -50.00 0% 0% 0.00 DHFSH13800 Installation of Kitchen Cabinet 12.00 01-Jun-15 14-Jun-15 01-Aug-15 13-Aug-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 92.00 06-Aug-14 04-Apr-15 01-Sep-14 A 21-Jan-15 102.00 0% 0% 0.00 DHFSH13240 Corridor/Lift Lobby Floor Screed 4.00 06-Aug-14 11-Aug-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00 DHFSH13270 Lift Lobby Painting - Primer & Stucco 6.00 11-Aug-14 18-Aug-14 25-Sep-14 A 07-Oct-14 46.00 100% 35% 0.00 DHFSH13310 Lift Lobby False Ceiling Suspension 6.00 09-Oct-14 16-Oct-14 27-Nov-14 04-Dec-14 4.00 0% 0% 0.00 DHFSH13360 Lift Lobby False Ceiling Tiling / Boarding 5.00 15-Nov-14 19-Nov-14 09-Dec-14 14-Dec-14 101.00 0% 0% 0.00 DHFSH13410 Lift Lobby Painting - 1st Coat 6.00 20-Nov-14 26-Nov-14 15-Dec-14 21-Dec-14 101.00 0% 0% 0.00 DHFSH13440 Installation of Steel Doors & Windows 3.00 01-Apr-15 04-Apr-15 11-Jan-15 13-Jan-15 69.00 0% 0% 0.00 DHFSH13470 Lift Lobby Flooring 6.00 18-Dec-14 24-Dec-14 08-Jan-15 14-Jan-15 102.00 0% 0% 0.00 DHFSH13490 Utility Rooms- Epoxy Flooring 6.00 25-Dec-14 31-Dec-14 15-Jan-15 21-Jan-15 102.00 0% 0% 0.00 Staircase 92.00 27-Jul-14 12-Apr-15 01-Oct-14 21-Jan-15 83.00 45.08% 0% 0.00 DHFSH13200 Staircase Plastering 4.00 27-Jul-14 03-Aug-14 01-Oct-14 07-Oct-14 142.00 100% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Construction of Horizontals - L13 Construction of Verticals - L13 Stair # 2 Stair # 1 Dry Area Floor Screed Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 16 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 61.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH13280 Staircase Painting - Primer & Stucco 6.00 18-Aug-14 25-Aug-14 08-Oct-14 14-Oct-14 142.00 100% 0% 0.00 DHFSH13320 Staircase Handrail Fixing 3.00 29-Dec-14 03-Jan-15 10-Nov-14 12-Nov-14 131.00 0% 0% 0.00 DHFSH13330 Staircase Painting 1st Coat 3.00 03-Jan-15 06-Jan-15 21-Dec-14 23-Dec-14 100.00 0% 0% 0.00 DHFSH13340 Staircase Final Painting 5.00 05-Apr-15 09-Apr-15 14-Jan-15 19-Jan-15 83.00 0% 0% 0.00 DHFSH13380 Staircase Epoxy Flooring 2.00 11-Apr-15 12-Apr-15 20-Jan-15 21-Jan-15 83.00 0% 0% 0.00 General 293.00 25-May-14 15-Jul-15 07-Jun-14 A 09-Sep-15 -43.00 0% 0% 0.00 DHSTR13000 Access from Structure 0.00 25-May-14 07-Jun-14 A 100% 100% 0.00 DHFSH13510 Snagging & De-Snagging 12.00 02-Jul-15 15-Jul-15 27-Aug-15 09-Sep-15 -43.00 0% 0% 0.00 MEP - LEVEL 13 428.00 28-Apr-14 08-Jun-15 25-Apr-14 A 04-Aug-15 -44.00 69.07% 69.97% 1.01 DHMEP13000 Embeded Conduits & Boxex - Concrete Works 3.00 28-Apr-14 30-Apr-14 25-Apr-14 A 01-May-14 A 100% 100% 0.00 DHMEP13100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C26a-bMlianyg- ,1 4Wiring et1c6-Jun-14 07-Jun-14 A 06-Aug-14 A 100% 100% 1.00 DHMEP13130 Cable Trays & Cable Trunking 6.00 24-Jun-14 30-Jun-14 07-Jun-14 A 06-Aug-14 A 100% 100% 0.00 DHMEP13120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 29-Jun-14 05-Jul-14 13-Jul-14 A 08-Sep-14 A 100% 100% 1.00 DHMEP13160 Pressure Testing of Pipes 12.00 06-Jul-14 19-Jul-14 30-Jul-14 A 08-Oct-14 50.00 100% 63% 0.00 DHMEP13110 MEP Works in Risers& Clearance 5.00 20-Aug-14 25-Aug-14 15-Jun-14 A 18-Oct-14 -33.00 100% 69% 0.00 DHMEP13140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es08-Nov-14 13-Nov-14 13-Aug-14 A 08-Dec-14 4.00 0% 31% 0.00 DHMEP13150 MEP Final Fixes 6.00 18-May-15 24-May-15 15-Jul-15 23-Jul-15 -44.00 0% 0% 0.00 DHMEP06250 Sanitary ware /Toilet accessories 6.00 21-May-15 27-May-15 21-Jul-15 27-Jul-15 -44.00 0% 0% 0.00 DHMEP13200 Pre-Testing & Commissioning 7.00 01-Jun-15 08-Jun-15 28-Jul-15 04-Aug-15 -44.00 0% 0% 0.00 LEVEL 14 462.00 19-Apr-14 25-Jul-15 24-Feb-14 A 16-Sep-15 -43.00 69.77% 68.86% 0.99 STRUCTURAL WORKS - LEVEL 14 18.00 19-Apr-14 08-May-14 21-Apr-14 A 11-May-14 A 100% 100% 1.00 DHCWA15100 Core Wall - Level 14 4.00 19-Apr-14 22-Apr-14 21-Apr-14 A 27-Apr-14 A 100% 100% 1.00 DHSLA14100 Construction of Horizontals - L14 3.00 04-May-14 06-May-14 03-May-14 A 08-May-14 A 100% 100% 1.00 DHCWA15110 Construction of Verticals - L14 2.00 07-May-14 08-May-14 09-May-14 A 11-May-14 A 100% 100% 1.00 STAIRCASES 4.00 20-Jul-14 23-Jul-14 16-Jul-14 A 20-Jul-14 A 0% 0% 0.00 A1460 Stair # 1 4.00 20-Jul-14 23-Jul-14 16-Jul-14 A 20-Jul-14 A 100% 100% 0.00 A1470 Stair # 2 3.00 21-Jul-14 23-Jul-14 17-Jul-14 A 20-Jul-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 14 299.00 02-Jun-14 25-Jul-15 24-Feb-14 A 16-Sep-15 -43.00 25.16% 19.64% 0.78 Dry area 276.00 24-Jun-14 28-Jun-15 24-Feb-14 A 27-Aug-15 -38.00 35.99% 35.49% 0.99 DHMEP14190 Dry Area Floor Screed 7.00 03-Aug-14 11-Aug-14 24-Feb-14 A 24-Feb-14 A 100% 100% 0.00 DHFSH14100 Block Work in Dry Area 6.00 24-Jun-14 30-Jun-14 24-Jun-14 A 20-Jul-14 A 100% 100% 1.00 DHFSH14120 Marking,Cutting & Chasing - Dry Area 4.00 01-Jul-14 05-Jul-14 13-Jul-14 A 10-Aug-14 A 100% 100% 1.00 DHFSH14130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 06-Jul-14 09-Jul-14 10-Aug-14 A 12-Aug-14 A 100% 100% 1.00 DHFSH14160 Plaster in Dry Area 8.00 22-Jul-14 03-Aug-14 17-Aug-14 A 08-Sep-14 A 100% 100% 1.00 DHFSH14230 Dry Area Painting - Primer 4.00 11-Aug-14 16-Aug-14 25-Sep-14 A 02-Oct-14 83.00 100% 50% 0.00 DHFSH14260 Dry Area Painting - Stucco 6.00 16-Aug-14 23-Aug-14 06-Oct-14 12-Oct-14 83.00 100% 0% 0.00 DHFSH14290 Dry Area False Ceiling Suspension 6.00 29-Sep-14 08-Oct-14 19-Nov-14 25-Nov-14 -15.00 18.75% 0% 0.00 DHFSH14350 Dry Area False Ceiling Tiling / Boarding 5.00 18-Nov-14 23-Nov-14 14-Dec-14 18-Dec-14 27.00 0% 0% 0.00 DHFSH14400 Dry Area Painting - 1st Coat 5.00 24-Nov-14 29-Nov-14 20-Dec-14 24-Dec-14 27.00 0% 0% 0.00 DHFSH14450 Dry Area Flooring 5.00 18-Dec-14 23-Dec-14 08-Jan-15 13-Jan-15 16.00 0% 0% 0.00 DHFSH14430 Installation of Timber Doors & Ironmongery 5.00 06-May-15 11-May-15 05-Jul-15 09-Jul-15 -50.00 0% 0% 0.00 DHFSH14802 Installation of Wardrobe 12.00 03-Jun-15 16-Jun-15 03-Aug-15 16-Aug-15 -50.00 0% 0% 0.00 DHFSH14500 Paint Final Coat 6.00 22-Jun-15 28-Jun-15 22-Aug-15 27-Aug-15 -38.00 0% 0% 0.00 Wet area 242.00 24-Jun-14 21-Jun-15 24-Jun-14 A 20-Aug-15 -50.00 14.4% 10.35% 0.72 DHFSH14110 Block Work in Wet Area 6.00 24-Jun-14 30-Jun-14 24-Jun-14 A 20-Jul-14 A 100% 100% 0.00 DHFSH14140 Marking,Cutting & Chasing - Wet Area 4.00 01-Jul-14 05-Jul-14 13-Jul-14 A 10-Aug-14 A 100% 100% 1.00 DHFSH14150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 06-Jul-14 09-Jul-14 10-Aug-14 A 12-Aug-14 A 100% 100% 1.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - Level 14 Construction of Horizontals - L14 Construction of Verticals - L14 Stair # 1 Stair # 2 Dry Area Floor Screed Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 17 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 62.
    Activity ID ActivityName Original Duration DAMAC Gulf Properties L.L.C Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHMEP14170 Plaster in Wet Area 4.00 13-Jul-14 16-Jul-14 17-Aug-14 A 08-Sep-14 A 100% 100% 1.00 DHMEP14180 Wet Area Wall Tiling 6.00 29-Sep-14 08-Oct-14 06-Nov-14 12-Nov-14 1.00 18.75% 0% 0.00 DHFSH14300 Wet Area False Ceiling Suspension 5.00 08-Oct-14 14-Oct-14 26-Nov-14 01-Dec-14 5.00 0% 0% 0.00 DHFSH14370 Wet Area False Ceiling Tiling/Boarding 4.00 18-Nov-14 22-Nov-14 14-Dec-14 17-Dec-14 5.00 0% 0% 0.00 DHFSH14210 Wet Area Waterproofing 4.00 23-Nov-14 26-Nov-14 18-Dec-14 22-Dec-14 5.00 0% 0% 0.00 DHFSH14220 Wet Area Floor Screed 4.00 27-Nov-14 01-Dec-14 23-Dec-14 27-Dec-14 5.00 0% 0% 0.00 DHFSH14250 Wet Area Floor Tiling 5.00 03-Dec-14 08-Dec-14 28-Dec-14 03-Jan-15 5.00 0% 0% 0.00 DHFSH06580 Cabinet Carcass 5.00 21-Dec-14 25-Dec-14 11-Jan-15 15-Jan-15 -1.00 0% 0% 0.00 DHFSH14420 Installation of Shower Enclosure 4.00 11-May-15 14-May-15 09-Jul-15 13-Jul-15 -37.00 0% 0% 0.00 DHFSH14390 Installation of Vanity Counters & Tops 5.00 12-May-15 18-May-15 11-Jul-15 15-Jul-15 -50.00 0% 0% 0.00 DHFSH14800 Installation of Kitchen Cabinet 12.00 08-Jun-15 21-Jun-15 08-Aug-15 20-Aug-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 97.00 11-Aug-14 07-Apr-15 01-Sep-14 A 27-Jan-15 99.00 0% 0% 0.00 DHFSH14240 Corridor/Lift Lobby Floor Screed 4.00 11-Aug-14 16-Aug-14 01-Sep-14 A 01-Sep-14 A 100% 100% 0.00 DHFSH14270 Lift Lobby Painting - Primer & Stucco 6.00 16-Aug-14 23-Aug-14 25-Sep-14 A 08-Oct-14 50.00 100% 15% 0.00 DHFSH14310 Lift Lobby False Ceiling Suspension 6.00 14-Oct-14 21-Oct-14 03-Dec-14 09-Dec-14 5.00 0% 0% 0.00 DHFSH14360 Lift Lobby False Ceiling Tiling / Boarding 5.00 18-Nov-14 23-Nov-14 14-Dec-14 18-Dec-14 100.00 0% 0% 0.00 DHFSH14410 Lift Lobby Painting - 1st Coat 6.00 24-Nov-14 30-Nov-14 20-Dec-14 25-Dec-14 100.00 0% 0% 0.00 DHFSH14440 Installation of Steel Doors & Windows 3.00 05-Apr-15 07-Apr-15 17-Jan-15 19-Jan-15 67.00 0% 0% 0.00 DHFSH14470 Lift Lobby Flooring 6.00 24-Dec-14 30-Dec-14 14-Jan-15 20-Jan-15 99.00 0% 0% 0.00 DHFSH14490 Utility Rooms- Epoxy Flooring 6.00 31-Dec-14 07-Jan-15 21-Jan-15 27-Jan-15 99.00 0% 0% 0.00 Staircase 97.00 03-Aug-14 15-Apr-15 01-Oct-14 27-Jan-15 84.00 45.08% 0% 0.00 DHFSH14200 Staircase Plastering 4.00 03-Aug-14 07-Aug-14 01-Oct-14 07-Oct-14 92.00 100% 0% 0.00 DHFSH14280 Staircase Painting - Primer & Stucco 6.00 23-Aug-14 30-Aug-14 09-Oct-14 15-Oct-14 144.00 100% 0% 0.00 DHFSH14320 Staircase Handrail Fixing 3.00 03-Jan-15 06-Jan-15 13-Nov-14 16-Nov-14 134.00 0% 0% 0.00 DHFSH14330 Staircase Painting 1st Coat 3.00 06-Jan-15 10-Jan-15 25-Dec-14 28-Dec-14 102.00 0% 0% 0.00 DHFSH14340 Staircase Final Painting 5.00 08-Apr-15 13-Apr-15 20-Jan-15 25-Jan-15 84.00 0% 0% 0.00 DHFSH14380 Staircase Epoxy Flooring 2.00 14-Apr-15 15-Apr-15 26-Jan-15 27-Jan-15 84.00 0% 0% 0.00 General 299.00 02-Jun-14 25-Jul-15 12-Jun-14 A 16-Sep-15 -43.00 0% 0% 0.00 DHSTR14000 Access from Structure 0.00 02-Jun-14 12-Jun-14 A 100% 100% 0.00 DHFSH14510 Snagging & De-Snagging 12.00 09-Jul-15 25-Jul-15 03-Sep-15 16-Sep-15 -43.00 0% 0% 0.00 MEP - LEVEL 14 431.00 04-May-14 15-Jun-15 03-May-14 A 11-Aug-15 -44.00 69.07% 69.97% 1.01 DHMEP14000 Embeded Conduits & Boxex - Concrete Works 3.00 04-May-14 06-May-14 03-May-14 A 08-May-14 A 100% 100% 0.00 DHMEP14100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C02a-bJluinng-1 ,4 Wiring et2c2-Jun-14 12-Jun-14 A 05-Aug-14 A 100% 100% 1.00 DHMEP14130 Cable Trays & Cable Trunking 6.00 01-Jul-14 07-Jul-14 12-Jun-14 A 05-Aug-14 A 100% 100% 0.00 DHMEP14160 Pressure Testing of Pipes 12.00 13-Jul-14 26-Jul-14 30-Jul-14 A 12-Aug-14 A 100% 100% 0.00 DHMEP14120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 06-Jul-14 12-Jul-14 22-Jul-14 A 08-Sep-14 A 100% 100% 1.00 DHMEP14110 MEP Works in Risers& Clearance 5.00 26-Aug-14 31-Aug-14 14-Jul-14 A 23-Oct-14 -33.00 100% 69% 0.00 DHMEP14140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es11-Nov-14 17-Nov-14 16-Aug-14 A 13-Dec-14 5.00 0% 31% 0.00 DHMEP14150 MEP Final Fixes 6.00 23-May-15 28-May-15 22-Jul-15 28-Jul-15 -42.00 0% 0% 0.00 DHMEP06260 Sanitary ware /Toilet accessories 6.00 26-May-15 01-Jun-15 26-Jul-15 01-Aug-15 -42.00 0% 0% 0.00 DHMEP14200 Pre-Testing & Commissioning 7.00 08-Jun-15 15-Jun-15 04-Aug-15 11-Aug-15 -44.00 0% 0% 0.00 LEVEL 15 465.00 23-Apr-14 01-Aug-15 28-Apr-14 A 26-Sep-15 -43.00 69.31% 68.9% 0.99 STRUCTURAL WORKS -LEVEL 15 19.00 23-Apr-14 14-May-14 28-Apr-14 A 18-May-14 A 100% 100% 1.00 DHCWA16100 Core Wall - Level 15 9.00 23-Apr-14 03-May-14 28-Apr-14 A 05-May-14 A 100% 100% 1.00 DHSLA15100 Construction of Horizontals - L15 3.00 10-May-14 12-May-14 10-May-14 A 15-May-14 A 100% 100% 1.00 DHCWA16110 Construction of Verticals - L15 2.00 13-May-14 14-May-14 17-May-14 A 18-May-14 A 100% 100% 1.00 STAIRCASES 4.00 27-Jul-14 02-Aug-14 22-Jul-14 A 26-Jul-14 A 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Pressure Testing of Pipes Embeded Condiuts,Boxes and Sleeves in Walls MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - Level 15 Construction of Horizontals - L15 Construction of Verticals - L15 DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 18 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 63.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 A1480 Stair # 1 4.00 27-Jul-14 02-Aug-14 22-Jul-14 A 26-Jul-14 A 100% 100% 0.00 A1490 Stair # 2 3.00 30-Jul-14 02-Aug-14 22-Jul-14 A 26-Jul-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 15 305.00 08-Jun-14 01-Aug-15 19-Jun-14 A 26-Sep-15 -43.00 23.05% 19.64% 0.85 Dry area 282.00 29-Jun-14 05-Jul-15 02-Jul-14 A 03-Sep-15 -38.00 35.49% 35.49% 1.00 DHFSH15100 Block Work in Dry Area 6.00 29-Jun-14 05-Jul-14 02-Jul-14 A 20-Jul-14 A 100% 100% 1.00 DHFSH15120 Marking,Cutting & Chasing - Dry Area 4.00 06-Jul-14 09-Jul-14 09-Aug-14 A 12-Aug-14 A 100% 100% 1.00 DHFSH15130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 10-Jul-14 14-Jul-14 11-Aug-14 A 17-Aug-14 A 100% 100% 1.00 DHFSH15160 Plaster in Dry Area 8.00 27-Jul-14 07-Aug-14 17-Aug-14 A 13-Sep-14 A 100% 100% 1.00 DHMEP15190 Dry Area Floor Screed 7.00 07-Aug-14 16-Aug-14 01-Oct-14 11-Oct-14 42.00 100% 0% 0.00 DHFSH15230 Dry Area Painting - Primer 4.00 16-Aug-14 20-Aug-14 12-Oct-14 15-Oct-14 79.00 100% 0% 0.00 DHFSH15260 Dry Area Painting - Stucco 6.00 20-Aug-14 27-Aug-14 16-Oct-14 22-Oct-14 79.00 100% 0% 0.00 DHFSH15290 Dry Area False Ceiling Suspension 6.00 06-Oct-14 13-Oct-14 24-Nov-14 30-Nov-14 -15.00 0% 0% 0.00 DHFSH15350 Dry Area False Ceiling Tiling / Boarding 5.00 22-Nov-14 26-Nov-14 18-Dec-14 23-Dec-14 28.00 0% 0% 0.00 DHFSH15400 Dry Area Painting - 1st Coat 5.00 27-Nov-14 03-Dec-14 24-Dec-14 29-Dec-14 28.00 0% 0% 0.00 DHFSH15450 Dry Area Flooring 5.00 24-Dec-14 29-Dec-14 14-Jan-15 19-Jan-15 16.00 0% 0% 0.00 DHFSH15430 Installation of Timber Doors & Ironmongery 5.00 12-May-15 18-May-15 11-Jul-15 15-Jul-15 -50.00 0% 0% 0.00 DHFSH15802 Installation of Wardrobe 12.00 08-Jun-15 21-Jun-15 08-Aug-15 20-Aug-15 -50.00 0% 0% 0.00 DHFSH15500 Paint Final Coat 6.00 29-Jun-15 05-Jul-15 29-Aug-15 03-Sep-15 -38.00 0% 0% 0.00 Wet area 244.00 29-Jun-14 28-Jun-15 02-Jul-14 A 27-Aug-15 -50.00 10.35% 10.35% 1.00 DHFSH15110 Block Work in Wet Area 6.00 29-Jun-14 05-Jul-14 02-Jul-14 A 20-Jul-14 A 100% 100% 0.00 DHFSH15140 Marking,Cutting & Chasing - Wet Area 4.00 06-Jul-14 09-Jul-14 09-Aug-14 A 12-Aug-14 A 100% 100% 1.00 DHFSH15150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 10-Jul-14 14-Jul-14 11-Aug-14 A 17-Aug-14 A 100% 100% 1.00 DHMEP15170 Plaster in Wet Area 4.00 17-Jul-14 21-Jul-14 17-Aug-14 A 13-Sep-14 A 100% 100% 1.00 DHMEP15180 Wet Area Wall Tiling 6.00 06-Oct-14 13-Oct-14 11-Nov-14 17-Nov-14 1.00 0% 0% 0.00 DHFSH15300 Wet Area False Ceiling Suspension 5.00 13-Oct-14 19-Oct-14 01-Dec-14 07-Dec-14 5.00 0% 0% 0.00 DHFSH15370 Wet Area False Ceiling Tiling/Boarding 4.00 22-Nov-14 25-Nov-14 18-Dec-14 22-Dec-14 6.00 0% 0% 0.00 DHFSH15210 Wet Area Waterproofing 4.00 26-Nov-14 30-Nov-14 23-Dec-14 27-Dec-14 6.00 0% 0% 0.00 DHFSH15220 Wet Area Floor Screed 4.00 01-Dec-14 06-Dec-14 28-Dec-14 31-Dec-14 6.00 0% 0% 0.00 DHFSH15250 Wet Area Floor Tiling 5.00 07-Dec-14 11-Dec-14 03-Jan-15 07-Jan-15 6.00 0% 0% 0.00 DHFSH06590 Cabinet Carcass 5.00 27-Dec-14 31-Dec-14 17-Jan-15 21-Jan-15 -1.00 0% 0% 0.00 DHFSH15420 Installation of Shower Enclosure 4.00 18-May-15 21-May-15 15-Jul-15 21-Jul-15 -36.00 0% 0% 0.00 DHFSH15390 Installation of Vanity Counters & Tops 5.00 20-May-15 25-May-15 20-Jul-15 25-Jul-15 -50.00 0% 0% 0.00 DHFSH15800 Installation of Kitchen Cabinet 12.00 15-Jun-15 28-Jun-15 15-Aug-15 27-Aug-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 95.00 16-Aug-14 11-Apr-15 12-Oct-14 02-Feb-15 96.00 0% 0% 0.00 DHFSH15240 Corridor/Lift Lobby Floor Screed 4.00 16-Aug-14 20-Aug-14 12-Oct-14 15-Oct-14 42.00 100% 0% 0.00 DHFSH15270 Lift Lobby Painting - Primer & Stucco 6.00 20-Aug-14 27-Aug-14 16-Oct-14 22-Oct-14 42.00 100% 0% 0.00 DHFSH15310 Lift Lobby False Ceiling Suspension 6.00 19-Oct-14 27-Oct-14 08-Dec-14 14-Dec-14 5.00 0% 0% 0.00 DHFSH15360 Lift Lobby False Ceiling Tiling / Boarding 5.00 22-Nov-14 26-Nov-14 18-Dec-14 23-Dec-14 99.00 0% 0% 0.00 DHFSH15410 Lift Lobby Painting - 1st Coat 6.00 27-Nov-14 04-Dec-14 24-Dec-14 30-Dec-14 99.00 0% 0% 0.00 DHFSH15440 Installation of Steel Doors & Windows 3.00 08-Apr-15 11-Apr-15 22-Jan-15 25-Jan-15 65.00 0% 0% 0.00 DHFSH15470 Lift Lobby Flooring 6.00 30-Dec-14 06-Jan-15 20-Jan-15 26-Jan-15 96.00 0% 0% 0.00 DHFSH15490 Utility Rooms- Epoxy Flooring 6.00 07-Jan-15 13-Jan-15 27-Jan-15 02-Feb-15 96.00 0% 0% 0.00 Staircase 102.00 07-Aug-14 19-Apr-15 01-Oct-14 02-Feb-15 84.00 45.08% 0% 0.00 DHFSH15200 Staircase Plastering 4.00 07-Aug-14 12-Aug-14 01-Oct-14 07-Oct-14 148.00 100% 0% 0.00 DHFSH15280 Staircase Painting - Primer & Stucco 6.00 27-Aug-14 03-Sep-14 23-Oct-14 30-Oct-14 135.00 100% 0% 0.00 DHFSH15320 Staircase Handrail Fixing 3.00 06-Jan-15 10-Jan-15 17-Nov-14 19-Nov-14 136.00 0% 0% 0.00 DHFSH15330 Staircase Painting 1st Coat 3.00 10-Jan-15 13-Jan-15 30-Dec-14 03-Jan-15 103.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 19 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 64.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH15340 Staircase Final Painting 5.00 12-Apr-15 16-Apr-15 26-Jan-15 31-Jan-15 84.00 0% 0% 0.00 DHFSH15380 Staircase Epoxy Flooring 2.00 18-Apr-15 19-Apr-15 01-Feb-15 02-Feb-15 84.00 0% 0% 0.00 General 305.00 08-Jun-14 01-Aug-15 19-Jun-14 A 26-Sep-15 -43.00 0% 0% 0.00 DHSTR15000 Access from Structure 0.00 08-Jun-14 19-Jun-14 A 100% 100% 0.00 DHFSH15510 Snagging & De-Snagging 12.00 16-Jul-15 01-Aug-15 10-Sep-15 26-Sep-15 -43.00 0% 0% 0.00 MEP - LEVEL 15 434.00 10-May-14 22-Jun-15 10-May-14 A 18-Aug-15 -44.00 69.07% 69.97% 1.01 DHMEP15000 Embeded Conduits & Boxex - Concrete Works 3.00 10-May-14 12-May-14 10-May-14 A 15-May-14 A 100% 100% 0.00 DHMEP15100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C08a-bJluinng-1 ,4 Wiring et2c8-Jun-14 19-Jun-14 A 04-Aug-14 A 100% 100% 1.00 DHMEP15130 Cable Trays & Cable Trunking 6.00 06-Jul-14 12-Jul-14 19-Jun-14 A 04-Aug-14 A 100% 100% 0.00 DHMEP15160 Pressure Testing of Pipes 12.00 17-Jul-14 02-Aug-14 15-Jul-14 A 19-Aug-14 A 100% 100% 0.00 DHMEP15120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 10-Jul-14 16-Jul-14 04-Aug-14 A 10-Sep-14 A 100% 100% 1.00 DHMEP15110 MEP Works in Risers& Clearance 5.00 01-Sep-14 06-Sep-14 14-Jul-14 A 30-Oct-14 -33.00 100% 69% 0.00 DHMEP15140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es15-Nov-14 20-Nov-14 18-Aug-14 A 17-Dec-14 5.00 0% 31% 0.00 DHMEP15150 MEP Final Fixes 6.00 27-May-15 02-Jun-15 27-Jul-15 02-Aug-15 -40.00 0% 0% 0.00 DHMEP06270 Sanitary ware /Toilet accessories 6.00 31-May-15 06-Jun-15 30-Jul-15 05-Aug-15 -40.00 0% 0% 0.00 DHMEP15200 Pre-Testing & Commissioning 7.00 15-Jun-15 22-Jun-15 11-Aug-15 18-Aug-15 -44.00 0% 0% 0.00 LEVEL 16 496.00 04-May-14 08-Aug-15 05-May-14 A 22-Oct-15 -59.00 69.38% 68.9% 0.99 STRUCTURAL WORKS -LEVEL 16 121.00 04-May-14 20-May-14 05-May-14 A 23-May-14 A 100% 100% 1.00 DHCWA17120 Tower Crane Jump 1.00 08-May-14 08-May-14 05-May-14 A 05-May-14 A 100% 100% 0.00 DHCWA17100 Core Wall - Level 16 5.00 04-May-14 08-May-14 06-May-14 A 08-May-14 A 100% 100% 1.00 DHSLA16100 Construction of Horizontals- L16 3.00 15-May-14 18-May-14 16-May-14 A 20-May-14 A 100% 100% 1.00 DHCWA17110 Construction of Verticals - L16 2.00 19-May-14 20-May-14 21-May-14 A 23-May-14 A 100% 100% 1.00 STAIRCASES 4.00 04-Aug-14 07-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0% 0.00 A1500 Stair # 1 4.00 04-Aug-14 07-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00 A1510 Stair # 2 3.00 05-Aug-14 07-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 16 311.00 14-Jun-14 08-Aug-15 26-Jun-14 A 03-Oct-15 -43.00 23.05% 19.64% 0.85 Dry area 288.00 05-Jul-14 12-Jul-15 07-Jul-14 A 10-Sep-15 -38.00 35.49% 35.49% 1.00 DHFSH16100 Block Work in Dry Area 6.00 05-Jul-14 10-Jul-14 07-Jul-14 A 28-Jul-14 A 100% 100% 1.00 DHFSH16120 Marking,Cutting & Chasing - Dry Area 4.00 12-Jul-14 15-Jul-14 12-Aug-14 A 14-Aug-14 A 100% 100% 1.00 DHFSH16130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 16-Jul-14 20-Jul-14 18-Aug-14 A 26-Aug-14 A 100% 100% 1.00 DHFSH16160 Plaster in Dry Area 8.00 03-Aug-14 12-Aug-14 20-Aug-14 A 18-Sep-14 A 100% 100% 1.00 DHMEP16190 Dry Area Floor Screed 7.00 12-Aug-14 20-Aug-14 01-Oct-14 11-Oct-14 45.00 100% 0% 0.00 DHFSH16230 Dry Area Painting - Primer 4.00 20-Aug-14 25-Aug-14 12-Oct-14 15-Oct-14 84.00 100% 0% 0.00 DHFSH16260 Dry Area Painting - Stucco 6.00 25-Aug-14 01-Sep-14 16-Oct-14 22-Oct-14 84.00 100% 0% 0.00 DHFSH16290 Dry Area False Ceiling Suspension 6.00 11-Oct-14 18-Oct-14 29-Nov-14 06-Dec-14 -15.00 0% 0% 0.00 DHFSH16350 Dry Area False Ceiling Tiling / Boarding 5.00 25-Nov-14 30-Nov-14 23-Dec-14 28-Dec-14 29.00 0% 0% 0.00 DHFSH16400 Dry Area Painting - 1st Coat 5.00 01-Dec-14 07-Dec-14 29-Dec-14 04-Jan-15 29.00 0% 0% 0.00 DHFSH16450 Dry Area Flooring 5.00 30-Dec-14 05-Jan-15 20-Jan-15 25-Jan-15 16.00 0% 0% 0.00 DHFSH16430 Installation of Timber Doors & Ironmongery 5.00 18-May-15 23-May-15 15-Jul-15 22-Jul-15 -50.00 0% 0% 0.00 DHFSH16802 Installation of Wardrobe 12.00 15-Jun-15 28-Jun-15 15-Aug-15 27-Aug-15 -50.00 0% 0% 0.00 DHFSH16500 Paint Final Coat 6.00 06-Jul-15 12-Jul-15 05-Sep-15 10-Sep-15 -38.00 0% 0% 0.00 Wet area 246.00 05-Jul-14 05-Jul-15 07-Jul-14 A 03-Sep-15 -50.00 10.35% 10.35% 1.00 DHFSH16110 Block Work in Wet Area 6.00 05-Jul-14 10-Jul-14 07-Jul-14 A 28-Jul-14 A 100% 100% 0.00 DHFSH16140 Marking,Cutting & Chasing - Wet Area 4.00 12-Jul-14 15-Jul-14 12-Aug-14 A 14-Aug-14 A 100% 100% 1.00 DHFSH16150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 16-Jul-14 20-Jul-14 18-Aug-14 A 26-Aug-14 A 100% 100% 1.00 DHMEP16170 Plaster in Wet Area 4.00 23-Jul-14 27-Jul-14 20-Aug-14 A 18-Sep-14 A 100% 100% 1.00 DHMEP16180 Wet Area Wall Tiling 6.00 11-Oct-14 18-Oct-14 16-Nov-14 22-Nov-14 1.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Pressure Testing of Pipes Embeded Condiuts,Boxes and Sleeves in Walls MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Tower Crane Jump Core Wall - Level 16 Construction of Horizontals- L16 Construction of Verticals - L16 Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 20 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 65.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH16300 Wet Area False Ceiling Suspension 5.00 18-Oct-14 23-Oct-14 07-Dec-14 11-Dec-14 4.00 0% 0% 0.00 DHFSH16370 Wet Area False Ceiling Tiling/Boarding 4.00 25-Nov-14 29-Nov-14 23-Dec-14 27-Dec-14 6.00 0% 0% 0.00 DHFSH16210 Wet Area Waterproofing 4.00 30-Nov-14 04-Dec-14 28-Dec-14 31-Dec-14 6.00 0% 0% 0.00 DHFSH16220 Wet Area Floor Screed 4.00 06-Dec-14 09-Dec-14 03-Jan-15 06-Jan-15 6.00 0% 0% 0.00 DHFSH16250 Wet Area Floor Tiling 6.00 10-Dec-14 16-Dec-14 07-Jan-15 13-Jan-15 6.00 0% 0% 0.00 DHFSH06600 Cabinet Carcass 5.00 03-Jan-15 07-Jan-15 22-Jan-15 27-Jan-15 -1.00 0% 0% 0.00 DHFSH16420 Installation of Shower Enclosure 4.00 23-May-15 26-May-15 22-Jul-15 26-Jul-15 -37.00 0% 0% 0.00 DHFSH16390 Installation of Vanity Counters & Tops 5.00 25-May-15 30-May-15 25-Jul-15 29-Jul-15 -50.00 0% 0% 0.00 DHFSH16800 Installation of Kitchen Cabinet 12.00 22-Jun-15 05-Jul-15 22-Aug-15 03-Sep-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 100.00 20-Aug-14 14-Apr-15 12-Oct-14 08-Feb-15 93.00 0% 0% 0.00 DHFSH16240 Corridor/Lift Lobby Floor Screed 4.00 20-Aug-14 25-Aug-14 12-Oct-14 15-Oct-14 45.00 100% 0% 0.00 DHFSH16270 Lift Lobby Painting - Primer & Stucco 6.00 25-Aug-14 01-Sep-14 16-Oct-14 22-Oct-14 45.00 100% 0% 0.00 DHFSH16310 Lift Lobby False Ceiling Suspension 6.00 23-Oct-14 01-Nov-14 13-Dec-14 18-Dec-14 4.00 0% 0% 0.00 DHFSH16360 Lift Lobby False Ceiling Tiling / Boarding 5.00 25-Nov-14 30-Nov-14 23-Dec-14 28-Dec-14 98.00 0% 0% 0.00 DHFSH16410 Lift Lobby Painting - 1st Coat 6.00 01-Dec-14 08-Dec-14 29-Dec-14 05-Jan-15 98.00 0% 0% 0.00 DHFSH16440 Installation of Steel Doors & Windows 3.00 12-Apr-15 14-Apr-15 28-Jan-15 31-Jan-15 63.00 0% 0% 0.00 DHFSH16470 Lift Lobby Flooring 6.00 06-Jan-15 12-Jan-15 26-Jan-15 01-Feb-15 93.00 0% 0% 0.00 DHFSH16490 Utility Rooms- Epoxy Flooring 6.00 13-Jan-15 19-Jan-15 02-Feb-15 08-Feb-15 93.00 0% 0% 0.00 Staircase 107.00 12-Aug-14 22-Apr-15 01-Oct-14 08-Feb-15 83.00 45.08% 0% 0.00 DHFSH16200 Staircase Plastering 4.00 12-Aug-14 17-Aug-14 01-Oct-14 07-Oct-14 151.00 100% 0% 0.00 DHFSH16280 Staircase Painting - Primer & Stucco 6.00 01-Sep-14 08-Sep-14 23-Oct-14 30-Oct-14 138.00 100% 0% 0.00 DHFSH16320 Staircase Handrail Fixing 3.00 10-Jan-15 13-Jan-15 20-Nov-14 23-Nov-14 137.00 0% 0% 0.00 DHFSH16330 Staircase Painting 1st Coat 3.00 13-Jan-15 17-Jan-15 05-Jan-15 07-Jan-15 103.00 0% 0% 0.00 DHFSH16340 Staircase Final Painting 5.00 15-Apr-15 20-Apr-15 01-Feb-15 05-Feb-15 83.00 0% 0% 0.00 DHFSH16380 Staircase Epoxy Flooring 2.00 21-Apr-15 22-Apr-15 07-Feb-15 08-Feb-15 83.00 0% 0% 0.00 General 311.00 14-Jun-14 08-Aug-15 26-Jun-14 A 03-Oct-15 -43.00 0% 0% 0.00 DHSTR16000 Access from Structure 0.00 14-Jun-14 26-Jun-14 A 100% 100% 0.00 DHFSH16510 Snagging & De-Snagging 12.00 26-Jul-15 08-Aug-15 17-Sep-15 03-Oct-15 -43.00 0% 0% 0.00 MEP - LEVEL 16 496.00 15-May-14 29-Jun-15 16-May-14 A 22-Oct-15 -91.00 69.07% 69.82% 1.01 DHMEP16000 Embeded Conduits & Boxex - Concrete Works 3.00 15-May-14 18-May-14 16-May-14 A 20-May-14 A 100% 100% 0.00 DHMEP16100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C14a-bJluinng-1 ,4 Wiring et0c3-Jul-14 26-Jun-14 A 12-Aug-14 A 100% 100% 1.00 DHMEP16130 Cable Trays & Cable Trunking 6.00 12-Jul-14 17-Jul-14 26-Jun-14 A 12-Aug-14 A 100% 100% 0.00 DHMEP16160 Pressure Testing of Pipes 12.00 23-Jul-14 07-Aug-14 02-Aug-14 A 20-Aug-14 A 100% 100% 0.00 DHMEP16120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 16-Jul-14 22-Jul-14 04-Aug-14 A 15-Sep-14 A 100% 100% 1.00 DHMEP16110 MEP Works in Risers& Clearance 5.00 07-Sep-14 11-Sep-14 24-Jul-14 A 05-Nov-14 -33.00 100% 69% 0.00 DHMEP16140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es18-Nov-14 24-Nov-14 20-Aug-14 A 22-Dec-14 4.00 0% 26% 0.00 DHMEP16150 MEP Final Fixes 6.00 01-Jun-15 07-Jun-15 01-Aug-15 06-Aug-15 -40.00 0% 0% 0.00 DHMEP06280 Sanitary ware /Toilet accessories 6.00 04-Jun-15 10-Jun-15 04-Aug-15 10-Aug-15 -38.00 0% 0% 0.00 DHMEP16200 Pre-Testing & Commissioning 7.00 22-Jun-15 29-Jun-15 18-Aug-15 25-Aug-15 -44.00 0% 0% 0.00 DHMEP16010 Busbar - L16 to L20 20.00 05-Apr-15 27-Apr-15 29-Sep-15 22-Oct-15 -144.00 0% 0% 0.00 LEVEL 17 483.00 10-May-14 15-Aug-15 10-May-14 A 10-Oct-15 -43.00 69.41% 68.99% 0.99 STRUCTURAL WORKS - LEVEL 17 15.00 10-May-14 26-May-14 10-May-14 A 30-May-14 A 100% 100% 1.00 DHCWA18100 Core Wall - Level 17 5.00 10-May-14 14-May-14 10-May-14 A 14-May-14 A 100% 100% 1.00 DHSLA17100 Construction of Horizontals - L17 3.00 21-May-14 24-May-14 21-May-14 A 27-May-14 A 100% 100% 1.00 DHCWA18110 Construction of Verticals - L17 2.00 25-May-14 26-May-14 28-May-14 A 30-May-14 A 100% 100% 1.00 STAIRCASES 4.00 10-Aug-14 13-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0% 0.00 A1520 Stair # 1 4.00 10-Aug-14 13-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Pressure Testing of Pipes Embeded Condiuts,Boxes and Sleeves in Walls MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Busbar - L16 to L20 Core Wall - Level 17 Construction of Horizontals - L17 Construction of Verticals - L17 Stair # 1 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 21 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 66.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 A1530 Stair # 2 3.00 11-Aug-14 13-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 17 317.00 30-Jun-14 15-Aug-15 01-Jul-14 A 10-Oct-15 -43.00 23.05% 19.64% 0.85 Dry area 294.00 21-Jul-14 21-Jul-15 10-Jul-14 A 17-Sep-15 -38.00 35.49% 35.49% 1.00 DHFSH17100 Block Work in Dry Area 6.00 21-Jul-14 27-Jul-14 10-Jul-14 A 12-Aug-14 A 100% 100% 1.00 DHFSH17120 Marking,Cutting & Chasing - Dry Area 4.00 30-Jul-14 03-Aug-14 14-Aug-14 A 17-Aug-14 A 100% 100% 1.00 DHFSH17130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 04-Aug-14 07-Aug-14 28-Aug-14 A 02-Sep-14 A 100% 100% 1.00 DHFSH17160 Plaster in Dry Area 8.00 11-Aug-14 19-Aug-14 30-Aug-14 A 22-Sep-14 A 100% 100% 1.00 DHMEP17190 Dry Area Floor Screed 7.00 20-Aug-14 27-Aug-14 01-Oct-14 11-Oct-14 48.00 100% 0% 0.00 DHFSH17230 Dry Area Painting - Primer 4.00 28-Aug-14 01-Sep-14 12-Oct-14 15-Oct-14 89.00 100% 0% 0.00 DHFSH17260 Dry Area Painting - Stucco 6.00 02-Sep-14 08-Sep-14 16-Oct-14 22-Oct-14 89.00 100% 0% 0.00 DHFSH17290 Dry Area False Ceiling Suspension 6.00 15-Oct-14 22-Oct-14 04-Dec-14 10-Dec-14 -15.00 0% 0% 0.00 DHFSH17350 Dry Area False Ceiling Tiling / Boarding 5.00 29-Nov-14 04-Dec-14 28-Dec-14 03-Jan-15 30.00 0% 0% 0.00 DHFSH17400 Dry Area Painting - 1st Coat 5.00 06-Dec-14 10-Dec-14 04-Jan-15 08-Jan-15 30.00 0% 0% 0.00 DHFSH17450 Dry Area Flooring 5.00 06-Jan-15 11-Jan-15 26-Jan-15 31-Jan-15 16.00 0% 0% 0.00 DHFSH17430 Installation of Timber Doors & Ironmongery 5.00 23-May-15 27-May-15 22-Jul-15 27-Jul-15 -50.00 0% 0% 0.00 DHFSH17802 Installation of Wardrobe 12.00 22-Jun-15 05-Jul-15 22-Aug-15 03-Sep-15 -50.00 0% 0% 0.00 DHFSH17500 Paint Final Coat 6.00 13-Jul-15 21-Jul-15 12-Sep-15 17-Sep-15 -38.00 0% 0% 0.00 Wet area 248.00 21-Jul-14 12-Jul-15 10-Jul-14 A 10-Sep-15 -50.00 10.35% 10.35% 1.00 DHFSH17110 Block Work in Wet Area 6.00 21-Jul-14 27-Jul-14 10-Jul-14 A 12-Aug-14 A 100% 100% 0.00 DHFSH17140 Marking,Cutting & Chasing - Wet Area 4.00 30-Jul-14 03-Aug-14 14-Aug-14 A 17-Aug-14 A 100% 100% 1.00 DHFSH17150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 04-Aug-14 07-Aug-14 28-Aug-14 A 02-Sep-14 A 100% 100% 1.00 DHMEP17170 Plaster in Wet Area 4.00 11-Aug-14 14-Aug-14 30-Aug-14 A 22-Sep-14 A 100% 100% 1.00 DHMEP17180 Wet Area Wall Tiling 6.00 15-Oct-14 22-Oct-14 20-Nov-14 26-Nov-14 1.00 0% 0% 0.00 DHFSH17300 Wet Area False Ceiling Suspension 5.00 22-Oct-14 29-Oct-14 11-Dec-14 16-Dec-14 3.00 0% 0% 0.00 DHFSH17370 Wet Area False Ceiling Tiling/Boarding 4.00 29-Nov-14 03-Dec-14 28-Dec-14 31-Dec-14 8.00 0% 0% 0.00 DHFSH17210 Wet Area Waterproofing 4.00 04-Dec-14 08-Dec-14 03-Jan-15 06-Jan-15 8.00 0% 0% 0.00 DHFSH17220 Wet Area Floor Screed 4.00 09-Dec-14 13-Dec-14 07-Jan-15 11-Jan-15 8.00 0% 0% 0.00 DHFSH17250 Wet Area Floor Tiling 5.00 14-Dec-14 18-Dec-14 12-Jan-15 17-Jan-15 8.00 0% 0% 0.00 DHFSH06610 Cabinet Carcass 5.00 08-Jan-15 13-Jan-15 28-Jan-15 02-Feb-15 -1.00 0% 0% 0.00 DHFSH17420 Installation of Shower Enclosure 4.00 27-May-15 31-May-15 27-Jul-15 30-Jul-15 -38.00 0% 0% 0.00 DHFSH17390 Installation of Vanity Counters & Tops 5.00 30-May-15 03-Jun-15 29-Jul-15 03-Aug-15 -50.00 0% 0% 0.00 DHFSH17800 Installation of Kitchen Cabinet 12.00 29-Jun-15 12-Jul-15 29-Aug-15 10-Sep-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 105.00 28-Aug-14 18-Apr-15 12-Oct-14 14-Feb-15 90.00 0% 0% 0.00 DHFSH17240 Corridor/Lift Lobby Floor Screed 4.00 28-Aug-14 01-Sep-14 12-Oct-14 15-Oct-14 48.00 100% 0% 0.00 DHFSH17270 Lift Lobby Painting - Primer & Stucco 6.00 02-Sep-14 08-Sep-14 16-Oct-14 22-Oct-14 48.00 100% 0% 0.00 DHFSH17310 Lift Lobby False Ceiling Suspension 6.00 29-Oct-14 05-Nov-14 17-Dec-14 23-Dec-14 3.00 0% 0% 0.00 DHFSH17360 Lift Lobby False Ceiling Tiling / Boarding 5.00 29-Nov-14 04-Dec-14 28-Dec-14 03-Jan-15 97.00 0% 0% 0.00 DHFSH17410 Lift Lobby Painting - 1st Coat 6.00 06-Dec-14 11-Dec-14 04-Jan-15 10-Jan-15 97.00 0% 0% 0.00 DHFSH17440 Installation of Steel Doors & Windows 3.00 15-Apr-15 18-Apr-15 03-Feb-15 05-Feb-15 61.00 0% 0% 0.00 DHFSH17470 Lift Lobby Flooring 6.00 12-Jan-15 18-Jan-15 01-Feb-15 07-Feb-15 90.00 0% 0% 0.00 DHFSH17490 Utility Rooms- Epoxy Flooring 6.00 19-Jan-15 25-Jan-15 08-Feb-15 14-Feb-15 90.00 0% 0% 0.00 Staircase 112.00 20-Aug-14 26-Apr-15 01-Oct-14 14-Feb-15 82.00 45.08% 0% 0.00 DHFSH17200 Staircase Plastering 4.00 20-Aug-14 24-Aug-14 01-Oct-14 07-Oct-14 154.00 100% 0% 0.00 DHFSH17280 Staircase Painting - Primer & Stucco 6.00 09-Sep-14 15-Sep-14 23-Oct-14 30-Oct-14 141.00 100% 0% 0.00 DHFSH17320 Staircase Handrail Fixing 3.00 13-Jan-15 17-Jan-15 24-Nov-14 26-Nov-14 138.00 0% 0% 0.00 DHFSH17330 Staircase Painting 1st Coat 3.00 17-Jan-15 20-Jan-15 10-Jan-15 12-Jan-15 103.00 0% 0% 0.00 DHFSH17340 Staircase Final Painting 5.00 19-Apr-15 23-Apr-15 07-Feb-15 11-Feb-15 82.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 22 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 67.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH17380 Staircase Epoxy Flooring 2.00 25-Apr-15 26-Apr-15 12-Feb-15 14-Feb-15 82.00 0% 0% 0.00 General 317.00 30-Jun-14 15-Aug-15 01-Jul-14 A 10-Oct-15 -43.00 0% 0% 0.00 DHSTR17000 Access from Structure 0.00 30-Jun-14 01-Jul-14 A 100% 100% 0.00 DHFSH17510 Snagging & De-Snagging 12.00 02-Aug-15 15-Aug-15 27-Sep-15 10-Oct-15 -43.00 0% 0% 0.00 MEP - LEVEL 17 452.00 21-May-14 06-Jul-15 21-May-14 A 01-Sep-15 -44.00 69.07% 69.97% 1.01 DHMEP17000 Embeded Conduits & Boxex - Concrete Works 3.00 21-May-14 24-May-14 21-May-14 A 27-May-14 A 100% 100% 0.00 DHMEP17100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C30a-bJluinng-1 ,4 Wiring et2c0-Jul-14 01-Jul-14 A 26-Aug-14 A 100% 100% 1.00 DHMEP17130 Cable Trays & Cable Trunking 6.00 30-Jul-14 05-Aug-14 01-Jul-14 A 26-Aug-14 A 100% 100% 0.00 DHMEP17160 Pressure Testing of Pipes 12.00 11-Aug-14 24-Aug-14 03-Aug-14 A 27-Aug-14 A 100% 100% 0.00 DHMEP17120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 04-Aug-14 10-Aug-14 10-Aug-14 A 18-Sep-14 A 100% 100% 1.00 DHMEP17110 MEP Works in Risers& Clearance 5.00 13-Sep-14 17-Sep-14 26-Jul-14 A 11-Nov-14 -33.00 100% 69% 0.00 DHMEP17140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es22-Nov-14 27-Nov-14 27-Aug-14 A 27-Dec-14 3.00 0% 31% 0.00 DHMEP17150 MEP Final Fixes 6.00 06-Jun-15 11-Jun-15 05-Aug-15 11-Aug-15 -40.00 0% 0% 0.00 DHMEP06290 Sanitary ware /Toilet accessories 6.00 09-Jun-15 15-Jun-15 09-Aug-15 15-Aug-15 -36.00 0% 0% 0.00 DHMEP17200 Pre-Testing & Commissioning 7.00 29-Jun-15 06-Jul-15 25-Aug-15 01-Sep-15 -44.00 0% 0% 0.00 LEVEL 18 486.00 15-May-14 22-Aug-15 15-May-14 A 18-Oct-15 -43.00 69.44% 65.98% 0.95 STRUCTURAL WORKS -LEVEL 18 16.00 15-May-14 03-Jun-14 15-May-14 A 05-Jun-14 A 100% 100% 1.00 DHCWA19100 Core Wall - Level 18 5.00 15-May-14 20-May-14 15-May-14 A 19-May-14 A 100% 100% 1.00 DHSLA18100 Construction of Horizontals - L18 3.00 29-May-14 01-Jun-14 28-May-14 A 03-Jun-14 A 100% 100% 1.00 DHCWA19110 Construction of Verticals - L18 2.00 02-Jun-14 03-Jun-14 04-Jun-14 A 05-Jun-14 A 100% 100% 1.00 STAIRCASES 4.00 17-Aug-14 20-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0% 0.00 A1540 Stair # 1 4.00 17-Aug-14 20-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00 A1550 Stair # 2 3.00 18-Aug-14 20-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 18 323.00 03-Jul-14 22-Aug-15 06-Jul-14 A 18-Oct-15 -43.00 23.05% 6.45% 0.28 Dry area 298.00 30-Jul-14 28-Jul-15 15-Jul-14 A 27-Sep-15 -38.00 35.49% 13.7% 0.39 DHFSH18120 Marking,Cutting & Chasing - Dry Area 4.00 06-Aug-14 10-Aug-14 17-Aug-14 A 19-Aug-14 A 100% 100% 1.00 DHFSH18100 Block Work in Dry Area 6.00 30-Jul-14 05-Aug-14 15-Jul-14 A 01-Oct-14 1.00 100% 50% 0.50 DHFSH18130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 11-Aug-14 14-Aug-14 09-Sep-14 A 02-Oct-14 41.00 100% 20% 0.20 DHFSH18160 Plaster in Dry Area 8.00 18-Aug-14 26-Aug-14 06-Oct-14 A 14-Oct-14 41.00 100% 2% 0.02 DHMEP18190 Dry Area Floor Screed 7.00 27-Aug-14 03-Sep-14 15-Oct-14 22-Oct-14 41.00 100% 0% 0.00 DHFSH18230 Dry Area Painting - Primer 4.00 04-Sep-14 08-Sep-14 23-Oct-14 28-Oct-14 84.00 100% 0% 0.00 DHFSH18260 Dry Area Painting - Stucco 6.00 09-Sep-14 15-Sep-14 29-Oct-14 04-Nov-14 84.00 100% 0% 0.00 DHFSH18290 Dry Area False Ceiling Suspension 6.00 20-Oct-14 28-Oct-14 09-Dec-14 15-Dec-14 -15.00 0% 0% 0.00 DHFSH18350 Dry Area False Ceiling Tiling / Boarding 5.00 03-Dec-14 08-Dec-14 03-Jan-15 07-Jan-15 31.00 0% 0% 0.00 DHFSH18400 Dry Area Painting - 1st Coat 5.00 09-Dec-14 14-Dec-14 08-Jan-15 13-Jan-15 31.00 0% 0% 0.00 DHFSH18450 Dry Area Flooring 5.00 12-Jan-15 17-Jan-15 01-Feb-15 05-Feb-15 16.00 0% 0% 0.00 DHFSH18430 Installation of Timber Doors & Ironmongery 5.00 27-May-15 01-Jun-15 27-Jul-15 01-Aug-15 -50.00 0% 0% 0.00 DHFSH18802 Installation of Wardrobe 12.00 29-Jun-15 12-Jul-15 29-Aug-15 10-Sep-15 -50.00 0% 0% 0.00 DHFSH18500 Paint Final Coat 6.00 22-Jul-15 28-Jul-15 19-Sep-15 27-Sep-15 -38.00 0% 0% 0.00 Wet area 292.00 30-Jul-14 21-Jul-15 15-Jul-14 A 17-Sep-15 -50.00 10.35% 1.59% 0.15 DHFSH18140 Marking,Cutting & Chasing - Wet Area 4.00 06-Aug-14 10-Aug-14 17-Aug-14 A 19-Aug-14 A 100% 100% 1.00 DHFSH18110 Block Work in Wet Area 6.00 30-Jul-14 05-Aug-14 15-Jul-14 A 01-Oct-14 38.00 100% 50% 0.00 DHFSH18150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 11-Aug-14 14-Aug-14 09-Sep-14 A 02-Oct-14 38.00 100% 20% 0.20 DHMEP18170 Plaster in Wet Area 4.00 18-Aug-14 21-Aug-14 06-Oct-14 A 09-Oct-14 38.00 100% 2% 0.02 DHMEP18180 Wet Area Wall Tiling 7.00 19-Oct-14 28-Oct-14 24-Nov-14 01-Dec-14 1.00 0% 0% 0.00 DHFSH18300 Wet Area False Ceiling Suspension 5.00 28-Oct-14 03-Nov-14 16-Dec-14 21-Dec-14 2.00 0% 0% 0.00 DHFSH18370 Wet Area False Ceiling Tiling/Boarding 4.00 03-Dec-14 07-Dec-14 03-Jan-15 06-Jan-15 9.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Pressure Testing of Pipes Embeded Condiuts,Boxes and Sleeves in Walls MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - Level 18 Construction of Horizontals - L18 Construction of Verticals - L18 Stair # 1 Stair # 2 Marking,Cutting & Chasing - Dry Area Block Work in Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Marking,Cutting & Chasing - Wet Area Block Work in Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 23 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 68.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH18210 Wet Area Waterproofing 4.00 08-Dec-14 11-Dec-14 07-Jan-15 11-Jan-15 9.00 0% 0% 0.00 DHFSH18220 Wet Area Floor Screed 4.00 13-Dec-14 16-Dec-14 12-Jan-15 15-Jan-15 9.00 0% 0% 0.00 DHFSH18250 Wet Area Floor Tiling 5.00 17-Dec-14 22-Dec-14 17-Jan-15 21-Jan-15 9.00 0% 0% 0.00 DHFSH06620 Cabinet Carcass 5.00 14-Jan-15 19-Jan-15 03-Feb-15 08-Feb-15 -1.00 0% 0% 0.00 DHFSH18420 Installation of Shower Enclosure 4.00 01-Jun-15 04-Jun-15 01-Aug-15 04-Aug-15 -39.00 0% 0% 0.00 DHFSH18390 Installation of Vanity Counters & Tops 5.00 03-Jun-15 08-Jun-15 03-Aug-15 08-Aug-15 -50.00 0% 0% 0.00 DHFSH18800 Installation of Kitchen Cabinet 12.00 06-Jul-15 21-Jul-15 05-Sep-15 17-Sep-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 100.00 04-Sep-14 21-Apr-15 23-Oct-14 19-Feb-15 87.00 0% 0% 0.00 DHFSH18240 Corridor/Lift Lobby Floor Screed 4.00 04-Sep-14 08-Sep-14 23-Oct-14 28-Oct-14 41.00 100% 0% 0.00 DHFSH18270 Lift Lobby Painting - Primer & Stucco 6.00 09-Sep-14 15-Sep-14 29-Oct-14 04-Nov-14 41.00 100% 0% 0.00 DHFSH18310 Lift Lobby False Ceiling Suspension 6.00 03-Nov-14 10-Nov-14 22-Dec-14 28-Dec-14 2.00 0% 0% 0.00 DHFSH18360 Lift Lobby False Ceiling Tiling / Boarding 5.00 03-Dec-14 08-Dec-14 03-Jan-15 07-Jan-15 96.00 0% 0% 0.00 DHFSH18410 Lift Lobby Painting - 1st Coat 6.00 09-Dec-14 15-Dec-14 08-Jan-15 14-Jan-15 96.00 0% 0% 0.00 DHFSH18440 Installation of Steel Doors & Windows 3.00 19-Apr-15 21-Apr-15 09-Feb-15 11-Feb-15 59.00 0% 0% 0.00 DHFSH18470 Lift Lobby Flooring 6.00 18-Jan-15 24-Jan-15 07-Feb-15 12-Feb-15 87.00 0% 0% 0.00 DHFSH18490 Utility Rooms- Epoxy Flooring 6.00 25-Jan-15 31-Jan-15 14-Feb-15 19-Feb-15 87.00 0% 0% 0.00 Staircase 107.00 27-Aug-14 29-Apr-15 15-Oct-14 19-Feb-15 81.00 45.08% 0% 0.00 DHFSH18200 Staircase Plastering 5.00 27-Aug-14 01-Sep-14 15-Oct-14 20-Oct-14 146.00 100% 0% 0.00 DHFSH18280 Staircase Painting - Primer & Stucco 6.00 16-Sep-14 22-Sep-14 05-Nov-14 11-Nov-14 134.00 100% 0% 0.00 DHFSH18320 Staircase Handrail Fixing 3.00 17-Jan-15 20-Jan-15 27-Nov-14 30-Nov-14 139.00 0% 0% 0.00 DHFSH18330 Staircase Painting 1st Coat 3.00 20-Jan-15 24-Jan-15 14-Jan-15 17-Jan-15 103.00 0% 0% 0.00 DHFSH18340 Staircase Final Painting 5.00 22-Apr-15 27-Apr-15 12-Feb-15 17-Feb-15 81.00 0% 0% 0.00 DHFSH18380 Staircase Epoxy Flooring 2.00 28-Apr-15 29-Apr-15 18-Feb-15 19-Feb-15 81.00 0% 0% 0.00 General 323.00 03-Jul-14 22-Aug-15 06-Jul-14 A 18-Oct-15 -43.00 0% 0% 0.00 DHSTR18000 Access from Structure 0.00 03-Jul-14 06-Jul-14 A 100% 100% 0.00 DHFSH18510 Snagging & De-Snagging 12.00 09-Aug-15 22-Aug-15 04-Oct-15 18-Oct-15 -43.00 0% 0% 0.00 MEP - LEVEL 18 455.00 29-May-14 13-Jul-15 28-May-14 A 08-Sep-15 -44.00 69.07% 69.97% 1.01 DHMEP18000 Embeded Conduits & Boxex - Concrete Works 3.00 29-May-14 01-Jun-14 28-May-14 A 03-Jun-14 A 100% 100% 0.00 DHMEP18100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C06a-bJluinl-g1 4, Wiring et2c6-Jul-14 06-Jul-14 A 27-Aug-14 A 100% 100% 1.00 DHMEP18130 Cable Trays & Cable Trunking 6.00 06-Aug-14 12-Aug-14 06-Jul-14 A 27-Aug-14 A 100% 100% 0.00 DHMEP18120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 11-Aug-14 17-Aug-14 24-Aug-14 A 18-Sep-14 A 100% 100% 1.00 DHMEP18160 Pressure Testing of Pipes 12.00 18-Aug-14 31-Aug-14 16-Aug-14 A 23-Sep-14 A 100% 100% 0.00 DHMEP18110 MEP Works in Risers& Clearance 5.00 18-Sep-14 23-Sep-14 04-Aug-14 A 17-Nov-14 -33.00 100% 60% 0.00 DHMEP18140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es25-Nov-14 01-Dec-14 02-Sep-14 A 31-Dec-14 2.00 0% 31% 0.00 DHMEP18150 MEP Final Fixes 6.00 13-Jun-15 18-Jun-15 12-Aug-15 18-Aug-15 -36.00 0% 0% 0.00 DHMEP06300 Sanitary ware /Toilet accessories 6.00 16-Jun-15 22-Jun-15 16-Aug-15 22-Aug-15 -36.00 0% 0% 0.00 DHMEP18200 Pre-Testing & Commissioning 7.00 06-Jul-15 13-Jul-15 01-Sep-15 08-Sep-15 -44.00 0% 0% 0.00 LEVEL 19 489.00 21-May-14 29-Aug-15 20-May-14 A 25-Oct-15 -43.00 69.61% 69.2% 0.99 STRUCTURAL WORKS -LEVEL 19 106.00 21-May-14 09-Jun-14 20-May-14 A 12-Jun-14 A 100% 100% 1.00 DHCWA20120 Tower Crane Jump 1.00 26-May-14 26-May-14 20-May-14 A 20-May-14 A 100% 100% 0.00 DHCWA20100 Core Wall - Level 19 5.00 21-May-14 26-May-14 20-May-14 A 26-May-14 A 100% 100% 1.00 DHSLA191000 Construction of Horizontals - L19 3.00 04-Jun-14 07-Jun-14 04-Jun-14 A 09-Jun-14 A 100% 100% 1.00 DHCWA20110 Construction of Verticals - L19 2.00 08-Jun-14 09-Jun-14 10-Jun-14 A 12-Jun-14 A 100% 100% 1.00 STAIRCASES 4.00 24-Aug-14 27-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0% 0.00 A1560 Stair # 1 4.00 24-Aug-14 27-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00 A1570 Stair # 2 3.00 25-Aug-14 27-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 19 329.00 07-Jul-14 29-Aug-15 09-Jul-14 A 25-Oct-15 -43.00 23.05% 19.64% 0.85 Dry area 301.00 04-Aug-14 04-Aug-15 20-Jul-14 A 04-Oct-15 -38.00 35.49% 35.49% 1.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Tower Crane Jump Core Wall - Level 19 Construction of Horizontals - L19 Construction of Verticals - L19 Stair # 1 Stair # 2 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 24 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 69.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH19100 Block Work in Dry Area 6.00 04-Aug-14 10-Aug-14 20-Jul-14 A 24-Aug-14 A 100% 100% 1.00 DHFSH19120 Marking,Cutting & Chasing - Dry Area 4.00 11-Aug-14 14-Aug-14 19-Aug-14 A 24-Aug-14 A 100% 100% 1.00 DHFSH19130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 16-Aug-14 19-Aug-14 09-Sep-14 A 14-Sep-14 A 100% 100% 1.00 DHFSH19160 Plaster in Dry Area 9.00 23-Aug-14 01-Sep-14 14-Sep-14 A 24-Sep-14 A 100% 100% 1.00 DHMEP19190 Dry Area Floor Screed 7.00 02-Sep-14 09-Sep-14 09-Oct-14 16-Oct-14 49.00 100% 0% 0.00 DHFSH19230 Dry Area Painting - Primer 4.00 10-Sep-14 14-Sep-14 18-Oct-14 21-Oct-14 94.00 100% 0% 0.00 DHFSH19260 Dry Area Painting - Stucco 6.00 15-Sep-14 21-Sep-14 22-Oct-14 29-Oct-14 94.00 100% 0% 0.00 DHFSH19290 Dry Area False Ceiling Suspension 6.00 26-Oct-14 02-Nov-14 14-Dec-14 20-Dec-14 -15.00 0% 0% 0.00 DHFSH19350 Dry Area False Ceiling Tiling / Boarding 5.00 07-Dec-14 11-Dec-14 07-Jan-15 12-Jan-15 32.00 0% 0% 0.00 DHFSH19400 Dry Area Painting - 1st Coat 5.00 13-Dec-14 17-Dec-14 13-Jan-15 18-Jan-15 32.00 0% 0% 0.00 DHFSH19450 Dry Area Flooring 5.00 18-Jan-15 22-Jan-15 07-Feb-15 11-Feb-15 16.00 0% 0% 0.00 DHFSH19430 Installation of Timber Doors & Ironmongery 4.00 02-Jun-15 06-Jun-15 02-Aug-15 05-Aug-15 -50.00 0% 0% 0.00 DHFSH19802 Installation of Wardrobe 12.00 06-Jul-15 21-Jul-15 05-Sep-15 17-Sep-15 -50.00 0% 0% 0.00 DHFSH19500 Paint Final Coat 6.00 29-Jul-15 04-Aug-15 28-Sep-15 04-Oct-15 -38.00 0% 0% 0.00 Wet area 295.00 04-Aug-14 28-Jul-15 20-Jul-14 A 27-Sep-15 -50.00 10.35% 10.35% 1.00 DHFSH19110 Block Work in Wet Area 6.00 04-Aug-14 10-Aug-14 20-Jul-14 A 24-Aug-14 A 100% 100% 0.00 DHFSH19140 Marking,Cutting & Chasing - Wet Area 4.00 11-Aug-14 14-Aug-14 19-Aug-14 A 24-Aug-14 A 100% 100% 1.00 DHFSH19150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 16-Aug-14 19-Aug-14 09-Sep-14 A 14-Sep-14 A 100% 100% 1.00 DHMEP19170 Plaster in Wet Area 4.00 23-Aug-14 26-Aug-14 14-Sep-14 A 24-Sep-14 A 100% 100% 1.00 DHMEP19180 Wet Area Wall Tiling 7.00 23-Oct-14 02-Nov-14 29-Nov-14 07-Dec-14 1.00 0% 0% 0.00 DHFSH19300 Wet Area False Ceiling Suspension 5.00 02-Nov-14 08-Nov-14 21-Dec-14 25-Dec-14 1.00 0% 0% 0.00 DHFSH19370 Wet Area False Ceiling Tiling/Boarding 4.00 07-Dec-14 10-Dec-14 07-Jan-15 11-Jan-15 10.00 0% 0% 0.00 DHFSH19210 Wet Area Waterproofing 4.00 11-Dec-14 15-Dec-14 12-Jan-15 15-Jan-15 10.00 0% 0% 0.00 DHFSH19220 Wet Area Floor Screed 4.00 16-Dec-14 20-Dec-14 17-Jan-15 20-Jan-15 10.00 0% 0% 0.00 DHFHS19250 Wet Area Floor Tiling 5.00 21-Dec-14 25-Dec-14 21-Jan-15 26-Jan-15 10.00 0% 0% 0.00 DHFSH06630 Cabinet Carcass 5.00 20-Jan-15 25-Jan-15 09-Feb-15 14-Feb-15 -1.00 0% 0% 0.00 DHFSH19420 Installation of Shower Enclosure 4.00 06-Jun-15 09-Jun-15 05-Aug-15 09-Aug-15 -40.00 0% 0% 0.00 DHFSH19390 Installation of Vanity Counters & Tops 5.00 08-Jun-15 13-Jun-15 08-Aug-15 12-Aug-15 -50.00 0% 0% 0.00 DHFSH19800 Installation of Kitchen Cabinet 12.00 13-Jul-15 28-Jul-15 12-Sep-15 27-Sep-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 110.00 10-Sep-14 25-Apr-15 18-Oct-14 25-Feb-15 84.00 0% 0% 0.00 DHFSH19240 Corridor/Lift Lobby Floor Screed 4.00 10-Sep-14 14-Sep-14 18-Oct-14 21-Oct-14 49.00 100% 0% 0.00 DHFSH19270 Lift Lobby Painting - Primer & Stucco 6.00 15-Sep-14 21-Sep-14 22-Oct-14 29-Oct-14 49.00 100% 0% 0.00 DHFSH19310 Lift Lobby False Ceiling Suspension 6.00 08-Nov-14 15-Nov-14 27-Dec-14 03-Jan-15 1.00 0% 0% 0.00 DHFSH19360 Lift Lobby False Ceiling Tiling / Boarding 5.00 07-Dec-14 11-Dec-14 07-Jan-15 12-Jan-15 95.00 0% 0% 0.00 DHFSH19410 Lift Lobby Painting - 1st Coat 6.00 13-Dec-14 18-Dec-14 13-Jan-15 19-Jan-15 95.00 0% 0% 0.00 DHFSH19440 Installation of Steel Doors & Windows 3.00 22-Apr-15 25-Apr-15 15-Feb-15 17-Feb-15 57.00 0% 0% 0.00 DHFSH19470 Lift Lobby Flooring 6.00 24-Jan-15 29-Jan-15 12-Feb-15 18-Feb-15 84.00 0% 0% 0.00 DHFSH19490 Utility Rooms- Epoxy Flooring 6.00 31-Jan-15 05-Feb-15 19-Feb-15 25-Feb-15 84.00 0% 0% 0.00 Staircase 117.00 02-Sep-14 03-May-15 09-Oct-14 25-Feb-15 81.00 45.08% 0% 0.00 DHFSH19200 Staircase Plastering 4.00 02-Sep-14 06-Sep-14 09-Oct-14 13-Oct-14 155.00 100% 0% 0.00 DHFSH19280 Staircase Painting - Primer & Stucco 6.00 22-Sep-14 28-Sep-14 30-Oct-14 05-Nov-14 142.00 100% 0% 0.00 DHFSH19320 Staircase Handrail Fixing 3.00 20-Jan-15 24-Jan-15 01-Dec-14 04-Dec-14 140.00 0% 0% 0.00 DHFSH19330 Staircase Painting 1st Coat 3.00 24-Jan-15 27-Jan-15 19-Jan-15 21-Jan-15 103.00 0% 0% 0.00 DHFSH19340 Staircase Final Painting 5.00 26-Apr-15 30-Apr-15 18-Feb-15 23-Feb-15 81.00 0% 0% 0.00 DHFSH19380 Staircase Epoxy Flooring 2.00 02-May-15 03-May-15 24-Feb-15 25-Feb-15 81.00 0% 0% 0.00 General 329.00 07-Jul-14 29-Aug-15 09-Jul-14 A 25-Oct-15 -43.00 0% 0% 0.00 DHSTR19000 Access from Structure 0.00 07-Jul-14 09-Jul-14 A 100% 100% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 25 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 70.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH19510 Snagging & De-Snagging 12.00 16-Aug-15 29-Aug-15 11-Oct-15 25-Oct-15 -43.00 0% 0% 0.00 MEP - LEVEL 19 455.00 04-Jun-14 16-Jul-15 04-Jun-14 A 12-Sep-15 -44.00 69.41% 70.32% 1.01 DHMEP19000 Embeded Conduits & Boxex - Concrete Works 3.00 04-Jun-14 07-Jun-14 04-Jun-14 A 09-Jun-14 A 100% 100% 0.00 DHMEP19100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C12a-bJluinl-g1 4, Wiring et0c3-Aug-14 09-Jul-14 A 30-Aug-14 A 100% 100% 1.00 DHMEP19130 Cable Trays & Cable Trunking 6.00 11-Aug-14 17-Aug-14 09-Jul-14 A 30-Aug-14 A 100% 100% 0.00 DHMEP19120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 16-Aug-14 21-Aug-14 25-Aug-14 A 20-Sep-14 A 100% 100% 1.00 DHMEP19160 Pressure Testing of Pipes 12.00 23-Aug-14 04-Sep-14 17-Aug-14 A 12-Oct-14 68.00 100% 86% 0.00 DHMEP19110 MEP Works in Risers& Clearance 6.00 24-Sep-14 30-Sep-14 16-Aug-14 A 23-Nov-14 -33.00 100% 21% 0.00 DHMEP19140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es29-Nov-14 06-Dec-14 04-Sep-14 A 06-Jan-15 1.00 0% 31% 0.00 DHMEP19150 MEP Final Fixes 6.00 10-Jun-15 16-Jun-15 10-Aug-15 16-Aug-15 -40.00 0% 0% 0.00 DHMEP06310 Sanitary ware /Toilet accessories 6.00 17-Jun-15 23-Jun-15 17-Aug-15 23-Aug-15 -34.00 0% 0% 0.00 DHMEP19200 Pre-Testing & Commissioning 7.00 09-Jul-15 16-Jul-15 05-Sep-15 12-Sep-15 -44.00 0% 0% 0.00 LEVEL 20 504.00 28-May-14 05-Sep-15 27-May-14 A 01-Nov-15 -43.00 69.7% 68.58% 0.98 STRUCTURAL WORKS - LEVEL 20 16.00 28-May-14 15-Jun-14 27-May-14 A 18-Jun-14 A 100% 100% 1.00 DHCWA21100 Core Wall - Level 20 4.00 28-May-14 01-Jun-14 27-May-14 A 31-May-14 A 100% 100% 1.00 DHSLA20100 Construction of Horizontals - L20 3.00 10-Jun-14 12-Jun-14 11-Jun-14 A 14-Jun-14 A 100% 100% 1.00 DHCWA21110 Construction of Verticals - L20 2.00 14-Jun-14 15-Jun-14 15-Jun-14 A 18-Jun-14 A 100% 100% 1.00 STAIRCASES 4.00 01-Sep-14 04-Sep-14 02-Aug-14 A 06-Aug-14 A 0% 0% 0.00 A1580 Stair # 1 4.00 01-Sep-14 04-Sep-14 02-Aug-14 A 06-Aug-14 A 100% 100% 0.00 A1590 Stair # 2 3.00 02-Sep-14 04-Sep-14 02-Aug-14 A 06-Aug-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 20 335.00 13-Jul-14 05-Sep-15 14-Jul-14 A 01-Nov-15 -43.00 23.05% 17.59% 0.76 Dry area 307.00 10-Aug-14 11-Aug-15 29-Jul-14 A 11-Oct-15 -38.00 35.49% 33.03% 0.93 DHFSH20100 Block Work in Dry Area 6.00 10-Aug-14 16-Aug-14 29-Jul-14 A 25-Aug-14 A 100% 100% 1.00 DHFSH20120 Marking,Cutting & Chasing - Dry Area 4.00 17-Aug-14 20-Aug-14 21-Aug-14 A 27-Aug-14 A 100% 100% 1.00 DHFSH20130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 21-Aug-14 25-Aug-14 11-Sep-14 A 18-Sep-14 A 100% 100% 1.00 DHFSH20160 Plaster in Dry Area 8.00 28-Aug-14 06-Sep-14 14-Sep-14 A 11-Oct-14 50.00 100% 70% 0.70 DHMEP20190 Dry Area Floor Screed 7.00 07-Sep-14 14-Sep-14 12-Oct-14 19-Oct-14 50.00 100% 0% 0.00 DHFSH20230 Dry Area Painting - Primer 4.00 15-Sep-14 18-Sep-14 20-Oct-14 23-Oct-14 97.00 100% 0% 0.00 DHFSH20260 Dry Area Painting - Stucco 6.00 20-Sep-14 25-Sep-14 26-Oct-14 01-Nov-14 97.00 100% 0% 0.00 DHFSH20290 Dry Area False Ceiling Suspension 6.00 30-Oct-14 06-Nov-14 18-Dec-14 24-Dec-14 -15.00 0% 0% 0.00 DHFSH20350 Dry Area False Ceiling Tiling / Boarding 5.00 10-Dec-14 15-Dec-14 12-Jan-15 17-Jan-15 33.00 0% 0% 0.00 DHFSH20400 Dry Area Painting - 1st Coat 5.00 16-Dec-14 21-Dec-14 18-Jan-15 22-Jan-15 33.00 0% 0% 0.00 DHFSH20450 Dry Area Flooring 5.00 24-Jan-15 28-Jan-15 12-Feb-15 17-Feb-15 16.00 0% 0% 0.00 DHFSH20430 Installation of Timber Doors & Ironmongery 4.00 07-Jun-15 10-Jun-15 06-Aug-15 10-Aug-15 -50.00 0% 0% 0.00 DHFSH20802 Installation of Wardrobe 12.00 11-Jul-15 26-Jul-15 09-Sep-15 22-Sep-15 -50.00 0% 0% 0.00 DHFSH20500 Paint Final Coat 6.00 05-Aug-15 11-Aug-15 05-Oct-15 11-Oct-15 -38.00 0% 0% 0.00 Wet area 301.00 10-Aug-14 04-Aug-15 29-Jul-14 A 04-Oct-15 -50.00 10.35% 8.17% 0.79 DHFSH20110 Block Work in Wet Area 6.00 10-Aug-14 16-Aug-14 29-Jul-14 A 25-Aug-14 A 100% 100% 0.00 DHFSH20140 Marking,Cutting & Chasing - Wet Area 4.00 17-Aug-14 20-Aug-14 21-Aug-14 A 27-Aug-14 A 100% 100% 1.00 DHFSH20150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 21-Aug-14 25-Aug-14 11-Sep-14 A 18-Sep-14 A 100% 100% 1.00 DHMEP20170 Plaster in Wet Area 4.00 28-Aug-14 01-Sep-14 14-Sep-14 A 09-Oct-14 47.00 100% 70% 0.70 DHMEP20180 Wet Area Wall Tiling 6.00 30-Oct-14 06-Nov-14 06-Dec-14 11-Dec-14 1.00 0% 0% 0.00 DHFSH20300 Wet Area False Ceiling Suspension 5.00 06-Nov-14 12-Nov-14 25-Dec-14 30-Dec-14 0.00 0% 0% 0.00 DHFSH20370 Wet Area False Ceiling Tiling/Boarding 4.00 10-Dec-14 14-Dec-14 12-Jan-15 15-Jan-15 11.00 0% 0% 0.00 DHFSH20210 Wet Area Waterproofing 4.00 15-Dec-14 18-Dec-14 17-Jan-15 20-Jan-15 11.00 0% 0% 0.00 DHFSH20220 Wet Area Floor Screed 4.00 20-Dec-14 23-Dec-14 21-Jan-15 25-Jan-15 11.00 0% 0% 0.00 DHFSH20250 Wet Area Floor Tiling 5.00 24-Dec-14 29-Dec-14 26-Jan-15 31-Jan-15 11.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - Level 20 Construction of Horizontals - L20 Construction of Verticals - L20 Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 26 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 71.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH06640 Cabinet Carcass 5.00 26-Jan-15 31-Jan-15 15-Feb-15 19-Feb-15 -1.00 0% 0% 0.00 DHFSH20420 Installation of Shower Enclosure 4.00 10-Jun-15 14-Jun-15 10-Aug-15 13-Aug-15 -40.00 0% 0% 0.00 DHFSH20390 Installation of Vanity Counters & Tops 5.00 13-Jun-15 17-Jun-15 12-Aug-15 17-Aug-15 -50.00 0% 0% 0.00 DHFSH20800 Installation of Kitchen Cabinet 12.00 22-Jul-15 04-Aug-15 19-Sep-15 04-Oct-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 113.00 15-Sep-14 28-Apr-15 20-Oct-14 03-Mar-15 81.00 0% 0% 0.00 DHFSH20240 Corridor/Lift Lobby Floor Screed 4.00 15-Sep-14 18-Sep-14 20-Oct-14 23-Oct-14 50.00 100% 0% 0.00 DHFSH20270 Lift Lobby Painting - Primer & Stucco 6.00 20-Sep-14 25-Sep-14 26-Oct-14 01-Nov-14 50.00 100% 0% 0.00 DHFSH20310 Lift Lobby False Ceiling Suspension 6.00 12-Nov-14 19-Nov-14 31-Dec-14 07-Jan-15 0.00 0% 0% 0.00 DHFSH20360 Lift Lobby False Ceiling Tiling / Boarding 5.00 10-Dec-14 15-Dec-14 12-Jan-15 17-Jan-15 94.00 0% 0% 0.00 DHFSH20410 Lift Lobby Painting - 1st Coat 6.00 16-Dec-14 22-Dec-14 18-Jan-15 24-Jan-15 94.00 0% 0% 0.00 DHFSH20440 Installation of Steel Doors & Windows 3.00 26-Apr-15 28-Apr-15 21-Feb-15 23-Feb-15 55.00 0% 0% 0.00 DHFSH20470 Lift Lobby Flooring 6.00 29-Jan-15 04-Feb-15 18-Feb-15 24-Feb-15 81.00 0% 0% 0.00 DHFSH20490 Utility Rooms- Epoxy Flooring 6.00 05-Feb-15 11-Feb-15 25-Feb-15 03-Mar-15 81.00 0% 0% 0.00 Staircase 120.00 07-Sep-14 06-May-15 12-Oct-14 03-Mar-15 80.00 45.08% 0% 0.00 DHFSH20200 Staircase Plastering 4.00 07-Sep-14 10-Sep-14 12-Oct-14 15-Oct-14 156.00 100% 0% 0.00 DHFSH20280 Staircase Painting - Primer & Stucco 6.00 27-Sep-14 02-Oct-14 02-Nov-14 08-Nov-14 143.00 66.67% 0% 0.00 DHFSH20320 Staircase Handrail Fixing 3.00 24-Jan-15 27-Jan-15 06-Dec-14 08-Dec-14 140.00 0% 0% 0.00 DHFSH20330 Staircase Painting 1st Coat 3.00 27-Jan-15 31-Jan-15 24-Jan-15 26-Jan-15 102.00 0% 0% 0.00 DHFSH20340 Staircase Final Painting 5.00 29-Apr-15 04-May-15 24-Feb-15 01-Mar-15 80.00 0% 0% 0.00 DHFSH20380 Staircase Epoxy Flooring 2.00 05-May-15 06-May-15 02-Mar-15 03-Mar-15 80.00 0% 0% 0.00 General 335.00 13-Jul-14 05-Sep-15 14-Jul-14 A 01-Nov-15 -43.00 0% 0% 0.00 DHSTR20000 Access from Structure 0.00 13-Jul-14 14-Jul-14 A 100% 100% 0.00 DHFSH20510 Snagging & De-Snagging 12.00 23-Aug-15 05-Sep-15 19-Oct-15 01-Nov-15 -43.00 0% 0% 0.00 MEP - LEVEL 20 467.00 10-Jun-14 22-Jul-15 11-Jun-14 A 15-Sep-15 -44.00 69.55% 69.9% 1.01 DHMEP20000 Embeded Conduits & Boxex - Concrete Works 3.00 10-Jun-14 12-Jun-14 11-Jun-14 A 14-Jun-14 A 100% 100% 0.00 DHMEP20100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C15a-bJluinl-g1 4, Wiring et0c6-Aug-14 14-Jul-14 A 03-Sep-14 A 100% 100% 1.00 DHMEP20130 Cable Trays & Cable Trunking 6.00 17-Aug-14 23-Aug-14 14-Jul-14 A 03-Sep-14 A 100% 100% 0.00 DHMEP20120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 21-Aug-14 27-Aug-14 25-Aug-14 A 22-Sep-14 A 100% 100% 1.00 DHMEP20160 Pressure Testing of Pipes 12.00 28-Aug-14 10-Sep-14 24-Aug-14 A 13-Oct-14 70.00 100% 53% 0.00 DHMEP20110 MEP Works in Risers& Clearance 6.00 01-Oct-14 09-Oct-14 17-Aug-14 A 29-Nov-14 -33.00 0% 21% 0.00 DHMEP20140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es03-Dec-14 09-Dec-14 07-Sep-14 A 11-Jan-15 0.00 0% 12% 0.00 DHMEP20150 MEP Final Fixes 6.00 15-Jun-15 21-Jun-15 15-Aug-15 20-Aug-15 -40.00 0% 0% 0.00 DHMEP06320 Sanitary ware /Toilet accessories 6.00 18-Jun-15 24-Jun-15 18-Aug-15 24-Aug-15 -32.00 0% 0% 0.00 DHMEP20200 Pre-Testing & Commissioning 7.00 13-Jul-15 22-Jul-15 08-Sep-15 15-Sep-15 -44.00 0% 0% 0.00 LEVEL 21 515.00 02-Jun-14 12-Sep-15 01-Jun-14 A 14-Nov-15 -48.00 69.72% 67.71% 0.97 STRUCTURAL WORKS - LEVEL 21 17.00 02-Jun-14 21-Jun-14 01-Jun-14 A 24-Jun-14 A 100% 100% 1.00 DHCWA22100 Core Wall - Level 21 4.00 02-Jun-14 05-Jun-14 01-Jun-14 A 06-Jun-14 A 100% 100% 1.00 DHSLA21100 Construction of Horizontals - L21 3.00 16-Jun-14 18-Jun-14 18-Jun-14 A 21-Jun-14 A 100% 100% 1.00 DHCWA22110 Construction of Verticals - L21 2.00 19-Jun-14 21-Jun-14 22-Jun-14 A 24-Jun-14 A 100% 100% 1.00 STAIRCASES 4.00 07-Sep-14 10-Sep-14 07-Aug-14 A 12-Aug-14 A 0% 0% 0.00 A1600 Stair # 1 4.00 07-Sep-14 10-Sep-14 07-Aug-14 A 12-Aug-14 A 100% 100% 0.00 A1610 Stair # 2 3.00 08-Sep-14 10-Sep-14 07-Aug-14 A 12-Aug-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 21 341.00 20-Jul-14 12-Sep-15 22-Jul-14 A 08-Nov-15 -43.00 23.05% 13.69% 0.59 Dry area 313.00 14-Aug-14 18-Aug-15 10-Aug-14 A 19-Oct-15 -38.00 35.49% 28.35% 0.80 DHFSH21120 Marking,Cutting & Chasing - Dry Area 4.00 21-Aug-14 25-Aug-14 12-Aug-14 A 24-Aug-14 A 100% 100% 1.00 DHFSH21100 Block Work in Dry Area 6.00 14-Aug-14 20-Aug-14 10-Aug-14 A 25-Aug-14 A 100% 100% 1.00 DHFSH21130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 26-Aug-14 30-Aug-14 15-Sep-14 A 21-Sep-14 A 100% 100% 1.00 DHFSH21160 Plaster in Dry Area 8.00 03-Sep-14 11-Sep-14 22-Sep-14 A 16-Oct-14 48.00 100% 13% 0.13 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - Level 21 Construction of Horizontals - L21 Construction of Verticals - L21 Stair # 1 Stair # 2 Marking,Cutting & Chasing - Dry Area Block Work in Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 27 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 72.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHMEP21190 Dry Area Floor Screed 7.00 13-Sep-14 20-Sep-14 18-Oct-14 26-Oct-14 48.00 100% 0% 0.00 DHFSH21230 Dry Area Painting - Primer 4.00 21-Sep-14 24-Sep-14 27-Oct-14 30-Oct-14 97.00 100% 0% 0.00 DHFSH21260 Dry Area Painting - Stucco 6.00 25-Sep-14 01-Oct-14 01-Nov-14 06-Nov-14 97.00 83.33% 0% 0.00 DHFSH21290 Dry Area False Ceiling Suspension 6.00 04-Nov-14 11-Nov-14 23-Dec-14 29-Dec-14 -15.00 0% 0% 0.00 DHFSH21350 Dry Area False Ceiling Tiling / Boarding 5.00 14-Dec-14 18-Dec-14 17-Jan-15 21-Jan-15 34.00 0% 0% 0.00 DHFSH21400 Dry Area Painting - 1st Coat 5.00 20-Dec-14 24-Dec-14 22-Jan-15 27-Jan-15 34.00 0% 0% 0.00 DHFSH21450 Dry Area Flooring 5.00 29-Jan-15 03-Feb-15 18-Feb-15 23-Feb-15 16.00 0% 0% 0.00 DHFSH21430 Installation of Timber Doors & Ironmongery 4.00 11-Jun-15 15-Jun-15 11-Aug-15 15-Aug-15 -50.00 0% 0% 0.00 DHFSH21802 Installation of Wardrobe 12.00 15-Jul-15 30-Jul-15 14-Sep-15 29-Sep-15 -50.00 0% 0% 0.00 DHFSH21500 Paint Final Coat 6.00 12-Aug-15 18-Aug-15 12-Oct-15 19-Oct-15 -38.00 0% 0% 0.00 Wet area 307.00 14-Aug-14 11-Aug-15 10-Aug-14 A 11-Oct-15 -50.00 10.35% 4.02% 0.39 DHFSH21140 Marking,Cutting & Chasing - Wet Area 5.00 21-Aug-14 26-Aug-14 12-Aug-14 A 24-Aug-14 A 100% 100% 1.00 DHFSH21110 Block Work in Wet Area 6.00 14-Aug-14 20-Aug-14 10-Aug-14 A 25-Aug-14 A 100% 100% 0.00 DHFSH21150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 27-Aug-14 31-Aug-14 15-Sep-14 A 21-Sep-14 A 100% 100% 1.00 DHMEP21170 Plaster in Wet Area 4.00 03-Sep-14 07-Sep-14 22-Sep-14 A 12-Oct-14 49.00 100% 13% 0.13 DHMEP21180 Wet Area Wall Tiling 6.00 04-Nov-14 11-Nov-14 10-Dec-14 16-Dec-14 1.00 0% 0% 0.00 DHFSH21300 Wet Area False Ceiling Suspension 5.00 11-Nov-14 17-Nov-14 30-Dec-14 05-Jan-15 -1.00 0% 0% 0.00 DHFSH21370 Wet Area False Ceiling Tiling/Boarding 4.00 14-Dec-14 17-Dec-14 17-Jan-15 20-Jan-15 12.00 0% 0% 0.00 DHFSH21210 Wet Area Waterproofing 4.00 18-Dec-14 22-Dec-14 21-Jan-15 25-Jan-15 12.00 0% 0% 0.00 DHFSH21220 Wet Area Floor Screed 4.00 23-Dec-14 27-Dec-14 26-Jan-15 29-Jan-15 12.00 0% 0% 0.00 DHFSH21250 Wet Area Floor Tiling 5.00 28-Dec-14 03-Jan-15 31-Jan-15 04-Feb-15 12.00 0% 0% 0.00 DHFSH06650 Cabinet Carcass 5.00 01-Feb-15 05-Feb-15 21-Feb-15 25-Feb-15 -1.00 0% 0% 0.00 DHFSH21420 Installation of Shower Enclosure 4.00 15-Jun-15 18-Jun-15 15-Aug-15 18-Aug-15 -40.00 0% 0% 0.00 DHFSH21390 Installation of Vanity Counters & Tops 5.00 17-Jun-15 22-Jun-15 17-Aug-15 22-Aug-15 -50.00 0% 0% 0.00 DHFSH21800 Installation of Kitchen Cabinet 12.00 29-Jul-15 11-Aug-15 28-Sep-15 11-Oct-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 113.00 21-Sep-14 02-May-15 27-Oct-14 09-Mar-15 78.00 0% 0% 0.00 DHFSH21240 Corridor/Lift Lobby Floor Screed 4.00 21-Sep-14 24-Sep-14 27-Oct-14 30-Oct-14 48.00 100% 0% 0.00 DHFSH21270 Lift Lobby Painting - Primer & Stucco 6.00 25-Sep-14 01-Oct-14 01-Nov-14 06-Nov-14 48.00 83.33% 0% 0.00 DHFSH21310 Lift Lobby False Ceiling Suspension 6.00 17-Nov-14 24-Nov-14 06-Jan-15 12-Jan-15 -1.00 0% 0% 0.00 DHFSH21360 Lift Lobby False Ceiling Tiling / Boarding 5.00 14-Dec-14 18-Dec-14 17-Jan-15 21-Jan-15 93.00 0% 0% 0.00 DHFSH21410 Lift Lobby Painting - 1st Coat 6.00 20-Dec-14 25-Dec-14 22-Jan-15 28-Jan-15 93.00 0% 0% 0.00 DHFSH21440 Installation of Steel Doors & Windows 3.00 29-Apr-15 02-May-15 26-Feb-15 01-Mar-15 53.00 0% 0% 0.00 DHFSH21470 Lift Lobby Flooring 6.00 04-Feb-15 10-Feb-15 24-Feb-15 02-Mar-15 78.00 0% 0% 0.00 DHFSH21490 Utility Rooms- Epoxy Flooring 6.00 11-Feb-15 17-Feb-15 03-Mar-15 09-Mar-15 78.00 0% 0% 0.00 Staircase 120.00 13-Sep-14 10-May-15 18-Oct-14 09-Mar-15 79.00 45.08% 0% 0.00 DHFSH21200 Staircase Plastering 4.00 13-Sep-14 16-Sep-14 18-Oct-14 21-Oct-14 154.00 100% 0% 0.00 DHFSH21280 Staircase Painting - Primer & Stucco 6.00 02-Oct-14 11-Oct-14 08-Nov-14 13-Nov-14 141.00 0% 0% 0.00 DHFSH21320 Staircase Handrail Fixing 3.00 27-Jan-15 31-Jan-15 09-Dec-14 11-Dec-14 140.00 0% 0% 0.00 DHFSH21330 Staircase Painting 1st Coat 3.00 31-Jan-15 03-Feb-15 28-Jan-15 31-Jan-15 101.00 0% 0% 0.00 DHFSH21340 Staircase Final Painting 5.00 03-May-15 07-May-15 02-Mar-15 07-Mar-15 79.00 0% 0% 0.00 DHFSH21380 Staircase Epoxy Flooring 2.00 09-May-15 10-May-15 08-Mar-15 09-Mar-15 79.00 0% 0% 0.00 General 341.00 20-Jul-14 12-Sep-15 22-Jul-14 A 08-Nov-15 -43.00 0% 0% 0.00 DHSTR21000 Access from Structure 0.00 20-Jul-14 22-Jul-14 A 100% 100% 0.00 DHFSH21510 Snagging & De-Snagging 12.00 30-Aug-15 12-Sep-15 26-Oct-15 08-Nov-15 -43.00 0% 0% 0.00 MEP - LEVEL 21 515.00 16-Jun-14 29-Jul-15 18-Jun-14 A 14-Nov-15 -86.00 69.55% 69.9% 1.01 DHMEP21000 Embeded Conduits & Boxex - Concrete Works 3.00 16-Jun-14 18-Jun-14 18-Jun-14 A 21-Jun-14 A 100% 100% 0.00 DHMEP21100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C20a-bJluinl-g1 4, Wiring et1c1-Aug-14 22-Jul-14 A 07-Sep-14 A 100% 100% 1.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Marking,Cutting & Chasing - Wet Area Block Work in Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 28 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 73.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHMEP21130 Cable Trays & Cable Trunking 6.00 21-Aug-14 27-Aug-14 22-Jul-14 A 07-Sep-14 A 100% 100% 0.00 DHMEP21120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 27-Aug-14 02-Sep-14 25-Aug-14 A 22-Sep-14 A 100% 100% 1.00 DHMEP21160 Pressure Testing of Pipes 12.00 03-Sep-14 16-Sep-14 27-Aug-14 A 13-Oct-14 73.00 100% 86% 0.00 DHMEP21110 MEP Works in Risers& Clearance 6.00 11-Oct-14 16-Oct-14 18-Aug-14 A 06-Dec-14 -33.00 0% 21% 0.00 DHMEP21140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es07-Dec-14 13-Dec-14 09-Sep-14 A 15-Jan-15 -1.00 0% 12% 0.00 DHMEP21150 MEP Final Fixes 6.00 20-Jun-15 25-Jun-15 19-Aug-15 25-Aug-15 -40.00 0% 0% 0.00 DHMEP06330 Sanitary ware /Toilet accessories 6.00 23-Jun-15 29-Jun-15 23-Aug-15 29-Aug-15 -30.00 0% 0% 0.00 DHMEP21200 Pre-Testing & Commissioning 7.00 22-Jul-15 29-Jul-15 15-Sep-15 22-Sep-15 -44.00 0% 0% 0.00 DHMEP21010 Busbar - L21to L25 19.00 28-Apr-15 20-May-15 24-Oct-15 14-Nov-15 -144.00 0% 0% 0.00 LEVEL 22 513.00 12-Jun-14 19-Sep-15 07-Jun-14 A 15-Nov-15 -43.00 69.75% 67.61% 0.97 STRUCTURAL WORKS - LEVEL 22 13.00 12-Jun-14 26-Jun-14 07-Jun-14 A 30-Jun-14 A 100% 100% 1.00 DHCWA23100 Core Wall - Level 22 4.00 12-Jun-14 16-Jun-14 07-Jun-14 A 10-Jun-14 A 100% 100% 1.00 DHSLA22100 Construction of Horizontals - L22 3.00 22-Jun-14 24-Jun-14 24-Jun-14 A 27-Jun-14 A 100% 100% 1.00 DHCWA23110 Construction of Verticals - L22 2.00 25-Jun-14 26-Jun-14 28-Jun-14 A 30-Jun-14 A 100% 100% 1.00 STAIRCASES 4.00 13-Sep-14 16-Sep-14 13-Aug-14 A 26-Aug-14 A 0% 0% 0.00 A1620 Stair # 1 4.00 13-Sep-14 16-Sep-14 13-Aug-14 A 18-Aug-14 A 100% 100% 0.00 A1630 Stair # 2 3.00 14-Sep-14 16-Sep-14 23-Aug-14 A 26-Aug-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 22 347.00 27-Jul-14 19-Sep-15 27-Jul-14 A 15-Nov-15 -43.00 23.05% 13.15% 0.57 Dry area 319.00 21-Aug-14 25-Aug-15 12-Aug-14 A 26-Oct-15 -38.00 35.49% 27.7% 0.78 DHFSH22100 Block Work in Dry Area 6.00 21-Aug-14 27-Aug-14 12-Aug-14 A 25-Aug-14 A 100% 100% 1.00 DHFSH22120 Marking,Cutting & Chasing - Dry Area 4.00 28-Aug-14 01-Sep-14 01-Sep-14 A 07-Sep-14 A 100% 100% 1.00 DHFSH22130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 02-Sep-14 06-Sep-14 21-Sep-14 A 26-Sep-14 A 100% 100% 1.00 DHFSH22160 Plaster in Dry Area 8.00 09-Sep-14 17-Sep-14 28-Sep-14 A 16-Oct-14 51.00 100% 5% 0.05 DHMEP22190 Dry Area Floor Screed 7.00 18-Sep-14 25-Sep-14 18-Oct-14 26-Oct-14 51.00 100% 0% 0.00 DHFSH22230 Dry Area Painting - Primer 4.00 27-Sep-14 30-Sep-14 27-Oct-14 30-Oct-14 102.00 100% 0% 0.00 DHFSH22260 Dry Area Painting - Stucco 6.00 01-Oct-14 09-Oct-14 01-Nov-14 06-Nov-14 102.00 0% 0% 0.00 DHFSH22290 Dry Area False Ceiling Suspension 6.00 09-Nov-14 16-Nov-14 28-Dec-14 04-Jan-15 -15.00 0% 0% 0.00 DHFSH22350 Dry Area False Ceiling Tiling / Boarding 5.00 17-Dec-14 22-Dec-14 21-Jan-15 26-Jan-15 35.00 0% 0% 0.00 DHFSH22400 Dry Area Painting - 1st Coat 5.00 23-Dec-14 28-Dec-14 27-Jan-15 01-Feb-15 35.00 0% 0% 0.00 DHFSH22450 Dry Area Flooring 5.00 04-Feb-15 09-Feb-15 24-Feb-15 01-Mar-15 16.00 0% 0% 0.00 DHFSH22430 Installation of Timber Doors & Ironmongery 4.00 16-Jun-15 20-Jun-15 16-Aug-15 19-Aug-15 -50.00 0% 0% 0.00 DHFSH22802 Installation of Wardrobe 12.00 22-Jul-15 04-Aug-15 19-Sep-15 04-Oct-15 -50.00 0% 0% 0.00 DHFSH22500 Paint Final Coat 6.00 19-Aug-15 25-Aug-15 20-Oct-15 26-Oct-15 -38.00 0% 0% 0.00 Wet area 313.00 21-Aug-14 18-Aug-15 12-Aug-14 A 19-Oct-15 -50.00 10.35% 3.44% 0.33 DHFSH22110 Block Work in Wet Area 6.00 21-Aug-14 27-Aug-14 12-Aug-14 A 25-Aug-14 A 100% 100% 0.00 DHFSH22140 Marking,Cutting & Chasing - Wet Area 4.00 28-Aug-14 01-Sep-14 01-Sep-14 A 07-Sep-14 A 100% 100% 1.00 DHFSH22150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 02-Sep-14 06-Sep-14 21-Sep-14 A 26-Sep-14 A 100% 100% 1.00 DHMEP22170 Plaster in Wet Area 4.00 09-Sep-14 13-Sep-14 28-Sep-14 A 12-Oct-14 53.00 100% 5% 0.05 DHMEP22180 Wet Area Wall Tiling 6.00 09-Nov-14 16-Nov-14 15-Dec-14 21-Dec-14 1.00 0% 0% 0.00 DHFSH22300 Wet Area False Ceiling Suspension 5.00 16-Nov-14 22-Nov-14 05-Jan-15 10-Jan-15 -2.00 0% 0% 0.00 DHFSH22370 Wet Area False Ceiling Tiling/Boarding 4.00 17-Dec-14 21-Dec-14 21-Jan-15 25-Jan-15 13.00 0% 0% 0.00 DHFSH22210 Wet Area Waterproofing 4.00 22-Dec-14 25-Dec-14 26-Jan-15 29-Jan-15 13.00 0% 0% 0.00 DHFSH22220 Wet Area Floor Screed 4.00 27-Dec-14 30-Dec-14 31-Jan-15 03-Feb-15 13.00 0% 0% 0.00 DHFSH22250 Wet Area Floor Tiling 5.00 31-Dec-14 06-Jan-15 04-Feb-15 09-Feb-15 13.00 0% 0% 0.00 DHFSH06660 Cabinet Carcass 5.00 07-Feb-15 11-Feb-15 26-Feb-15 03-Mar-15 -1.00 0% 0% 0.00 DHFSH22420 Installation of Shower Enclosure 4.00 20-Jun-15 23-Jun-15 19-Aug-15 23-Aug-15 -40.00 0% 0% 0.00 DHFSH22390 Installation of Vanity Counters & Tops 5.00 22-Jun-15 27-Jun-15 22-Aug-15 26-Aug-15 -50.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Busbar - L21to L25 Core Wall - Level 22 Construction of Horizontals - L22 Construction of Verticals - L22 Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 29 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 74.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH22800 Installation of Kitchen Cabinet 12.00 05-Aug-15 18-Aug-15 05-Oct-15 19-Oct-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 118.00 27-Sep-14 05-May-15 27-Oct-14 15-Mar-15 75.00 0% 0% 0.00 DHFSH22240 Corridor/Lift Lobby Floor Screed 4.00 27-Sep-14 30-Sep-14 27-Oct-14 30-Oct-14 51.00 100% 0% 0.00 DHFSH22270 Lift Lobby Painting - Primer & Stucco 6.00 01-Oct-14 09-Oct-14 01-Nov-14 06-Nov-14 51.00 0% 0% 0.00 DHFSH22310 Lift Lobby False Ceiling Suspension 6.00 22-Nov-14 29-Nov-14 11-Jan-15 17-Jan-15 -2.00 0% 0% 0.00 DHFSH22360 Lift Lobby False Ceiling Tiling / Boarding 5.00 17-Dec-14 22-Dec-14 21-Jan-15 26-Jan-15 92.00 0% 0% 0.00 DHFSH22410 Lift Lobby Painting - 1st Coat 6.00 23-Dec-14 29-Dec-14 27-Jan-15 02-Feb-15 92.00 0% 0% 0.00 DHFSH22440 Installation of Steel Doors & Windows 3.00 03-May-15 05-May-15 04-Mar-15 07-Mar-15 51.00 0% 0% 0.00 DHFSH22470 Lift Lobby Flooring 6.00 10-Feb-15 16-Feb-15 02-Mar-15 08-Mar-15 75.00 0% 0% 0.00 DHFSH22490 Utility Rooms- Epoxy Flooring 6.00 17-Feb-15 23-Feb-15 09-Mar-15 15-Mar-15 75.00 0% 0% 0.00 Staircase 125.00 18-Sep-14 13-May-15 18-Oct-14 15-Mar-15 78.00 45.08% 0% 0.00 DHFSH22200 Staircase Plastering 4.00 18-Sep-14 22-Sep-14 18-Oct-14 21-Oct-14 157.00 100% 0% 0.00 DHFSH22280 Staircase Painting - Primer & Stucco 6.00 11-Oct-14 16-Oct-14 08-Nov-14 13-Nov-14 144.00 0% 0% 0.00 DHFSH22320 Staircase Handrail Fixing 3.00 31-Jan-15 03-Feb-15 13-Dec-14 15-Dec-14 140.00 0% 0% 0.00 DHFSH22330 Staircase Painting 1st Coat 3.00 03-Feb-15 07-Feb-15 02-Feb-15 04-Feb-15 100.00 0% 0% 0.00 DHFSH22340 Staircase Final Painting 5.00 06-May-15 11-May-15 08-Mar-15 12-Mar-15 78.00 0% 0% 0.00 DHFSH22380 Staircase Epoxy Flooring 2.00 12-May-15 13-May-15 14-Mar-15 15-Mar-15 78.00 0% 0% 0.00 General 347.00 27-Jul-14 19-Sep-15 27-Jul-14 A 15-Nov-15 -43.00 0% 0% 0.00 DHSTR22000 Access from Structure 0.00 27-Jul-14 27-Jul-14 A 100% 100% 0.00 DHFSH22510 Snagging & De-Snagging 12.00 06-Sep-15 19-Sep-15 02-Nov-15 15-Nov-15 -43.00 0% 0% 0.00 MEP - LEVEL 22 476.00 22-Jun-14 05-Aug-15 24-Jun-14 A 01-Oct-15 -44.00 69.55% 69.9% 1.01 DHMEP22000 Embeded Conduits & Boxex - Concrete Works 3.00 22-Jun-14 24-Jun-14 24-Jun-14 A 27-Jun-14 A 100% 100% 0.00 DHMEP22100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C27a-bJluinl-g1 4, Wiring et1c8-Aug-14 27-Jul-14 A 09-Sep-14 A 100% 100% 1.00 DHMEP22130 Cable Trays & Cable Trunking 6.00 28-Aug-14 03-Sep-14 27-Jul-14 A 09-Sep-14 A 100% 100% 0.00 DHMEP22120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 02-Sep-14 08-Sep-14 08-Sep-14 A 17-Sep-14 A 100% 100% 1.00 DHMEP22160 Pressure Testing of Pipes 12.00 09-Sep-14 22-Sep-14 20-Aug-14 A 14-Oct-14 75.00 100% 53% 0.00 DHMEP22110 MEP Works in Risers& Clearance 6.00 18-Oct-14 23-Oct-14 19-Aug-14 A 11-Dec-14 -33.00 0% 16% 0.00 DHMEP22140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es10-Dec-14 16-Dec-14 11-Sep-14 A 20-Jan-15 -2.00 0% 12% 0.00 DHMEP22150 MEP Final Fixes 6.00 24-Jun-15 30-Jun-15 24-Aug-15 30-Aug-15 -40.00 0% 0% 0.00 DHMEP06340 Sanitary ware /Toilet accessories 6.00 28-Jun-15 04-Jul-15 27-Aug-15 02-Sep-15 -28.00 0% 0% 0.00 DHMEP22200 Pre-Testing & Commissioning 7.00 29-Jul-15 05-Aug-15 22-Sep-15 01-Oct-15 -44.00 0% 0% 0.00 LEVEL 23 516.00 17-Jun-14 28-Sep-15 12-Jun-14 A 22-Nov-15 -43.00 69.77% 67.34% 0.97 STRUCTURAL WORKS - LEVEL 23 84.00 17-Jun-14 06-Jul-14 12-Jun-14 A 08-Jul-14 A 100% 100% 1.00 DHCWA24100 Core Wall - Level 23 4.00 17-Jun-14 21-Jun-14 12-Jun-14 A 15-Jun-14 A 100% 100% 1.00 DHCWA24120 Tower Crane Jump 1.00 21-Jun-14 21-Jun-14 17-Jun-14 A 17-Jun-14 A 100% 100% 0.00 DHSLA23100 Construction of Horizontals- L23 5.00 28-Jun-14 02-Jul-14 27-Jun-14 A 04-Jul-14 A 100% 100% 1.00 DHCWA24110 Construction of Verticals - L23 3.00 03-Jul-14 06-Jul-14 04-Jul-14 A 08-Jul-14 A 100% 100% 1.00 STAIRCASES 4.00 17-Sep-14 21-Sep-14 18-Aug-14 A 23-Aug-14 A 0% 0% 0.00 A1640 Stair # 1 4.00 17-Sep-14 21-Sep-14 18-Aug-14 A 23-Aug-14 A 100% 100% 0.00 A1650 Stair # 2 3.00 18-Sep-14 21-Sep-14 18-Aug-14 A 23-Aug-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 23 353.00 04-Aug-14 28-Sep-15 04-Aug-14 A 22-Nov-15 -43.00 23.05% 11.84% 0.51 Dry area 325.00 26-Aug-14 01-Sep-15 25-Aug-14 A 02-Nov-15 -38.00 35.49% 26.13% 0.74 DHFSH23120 Marking,Cutting & Chasing - Dry Area 4.00 02-Sep-14 06-Sep-14 07-Sep-14 A 10-Sep-14 A 100% 100% 1.00 DHFSH23100 Block Work in Dry Area 6.00 26-Aug-14 01-Sep-14 25-Aug-14 A 15-Sep-14 A 100% 100% 1.00 DHFSH23130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 07-Sep-14 10-Sep-14 30-Sep-14 A 11-Oct-14 51.00 100% 50% 0.50 DHFSH23160 Plaster in Dry Area 8.00 14-Sep-14 22-Sep-14 12-Oct-14 20-Oct-14 51.00 100% 0% 0.00 DHMEP23190 Dry Area Floor Screed 7.00 23-Sep-14 30-Sep-14 21-Oct-14 29-Oct-14 51.00 100% 0% 0.00 DHFSH23230 Dry Area Painting - Primer 4.00 01-Oct-14 07-Oct-14 30-Oct-14 03-Nov-14 104.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - Level 23 Tower Crane Jump Construction of Horizontals- L23 Construction of Verticals - L23 Stair # 1 Stair # 2 Marking,Cutting & Chasing - Dry Area Block Work in Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 30 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 75.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH23260 Dry Area Painting - Stucco 6.00 08-Oct-14 14-Oct-14 04-Nov-14 10-Nov-14 104.00 0% 0% 0.00 DHFSH23290 Dry Area False Ceiling Suspension 6.00 13-Nov-14 20-Nov-14 12-Jan-15 19-Jan-15 -23.00 0% 0% 0.00 DHFSH23350 Dry Area False Ceiling Tiling / Boarding 5.00 21-Dec-14 25-Dec-14 04-Feb-15 10-Feb-15 28.00 0% 0% 0.00 DHFSH23400 Dry Area Painting - 1st Coat 5.00 27-Dec-14 31-Dec-14 10-Feb-15 16-Feb-15 28.00 0% 0% 0.00 DHFSH23450 Dry Area Flooring 5.00 10-Feb-15 15-Feb-15 02-Mar-15 07-Mar-15 16.00 0% 0% 0.00 DHFSH23430 Installation of Timber Doors & Ironmongery 4.00 21-Jun-15 24-Jun-15 20-Aug-15 24-Aug-15 -50.00 0% 0% 0.00 DHFSH23802 Installation of Wardrobe 12.00 29-Jul-15 11-Aug-15 28-Sep-15 11-Oct-15 -50.00 0% 0% 0.00 DHFSH23500 Paint Final Coat 6.00 26-Aug-15 01-Sep-15 27-Oct-15 02-Nov-15 -38.00 0% 0% 0.00 Wet area 319.00 26-Aug-14 25-Aug-15 25-Aug-14 A 26-Oct-15 -50.00 10.35% 2.05% 0.20 DHFSH23140 Marking,Cutting & Chasing - Wet Area 4.00 02-Sep-14 06-Sep-14 07-Sep-14 A 10-Sep-14 A 100% 100% 1.00 DHFSH23110 Block Work in Wet Area 6.00 26-Aug-14 01-Sep-14 25-Aug-14 A 15-Sep-14 A 100% 100% 0.00 DHFSH23150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 07-Sep-14 10-Sep-14 30-Sep-14 A 11-Oct-14 54.00 100% 50% 0.50 DHMEP23170 Plaster in Wet Area 4.00 14-Sep-14 17-Sep-14 12-Oct-14 15-Oct-14 54.00 100% 0% 0.00 DHMEP23180 Wet Area Wall Tiling 6.00 13-Nov-14 20-Nov-14 20-Dec-14 25-Dec-14 1.00 0% 0% 0.00 DHFSH23300 Wet Area False Ceiling Suspension 5.00 20-Nov-14 26-Nov-14 19-Jan-15 25-Jan-15 -11.00 0% 0% 0.00 DHFSH23370 Wet Area False Ceiling Tiling/Boarding 4.00 21-Dec-14 24-Dec-14 04-Feb-15 09-Feb-15 6.00 0% 0% 0.00 DHFSH23210 Wet Area Waterproofing 4.00 25-Dec-14 29-Dec-14 09-Feb-15 14-Feb-15 6.00 0% 0% 0.00 DHFSH23220 Wet Area Floor Screed 4.00 30-Dec-14 04-Jan-15 14-Feb-15 18-Feb-15 6.00 0% 0% 0.00 DHFSH23250 Wet Area Floor Tiling 5.00 05-Jan-15 10-Jan-15 18-Feb-15 24-Feb-15 6.00 0% 0% 0.00 DHFSH06670 Cabinet Carcass 5.00 12-Feb-15 17-Feb-15 04-Mar-15 09-Mar-15 -1.00 0% 0% 0.00 DHFSH23420 Installation of Shower Enclosure 4.00 24-Jun-15 28-Jun-15 24-Aug-15 27-Aug-15 -41.00 0% 0% 0.00 DHFSH23390 Installation of Vanity Counters & Tops 5.00 27-Jun-15 01-Jul-15 26-Aug-15 31-Aug-15 -50.00 0% 0% 0.00 DHFSH23800 Installation of Kitchen Cabinet 12.00 12-Aug-15 25-Aug-15 12-Oct-15 26-Oct-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 120.00 01-Oct-14 09-May-15 30-Oct-14 21-Mar-15 72.00 0% 0% 0.00 DHFSH23240 Corridor/Lift Lobby Floor Screed 4.00 01-Oct-14 07-Oct-14 30-Oct-14 03-Nov-14 51.00 0% 0% 0.00 DHFSH23270 Lift Lobby Painting - Primer & Stucco 6.00 08-Oct-14 14-Oct-14 04-Nov-14 10-Nov-14 51.00 0% 0% 0.00 DHFSH23310 Lift Lobby False Ceiling Suspension 6.00 26-Nov-14 04-Dec-14 25-Jan-15 01-Feb-15 -11.00 0% 0% 0.00 DHFSH23360 Lift Lobby False Ceiling Tiling / Boarding 5.00 21-Dec-14 25-Dec-14 04-Feb-15 10-Feb-15 83.00 0% 0% 0.00 DHFSH23410 Lift Lobby Painting - 1st Coat 6.00 27-Dec-14 03-Jan-15 10-Feb-15 17-Feb-15 83.00 0% 0% 0.00 DHFSH23440 Installation of Steel Doors & Windows 3.00 06-May-15 09-May-15 10-Mar-15 12-Mar-15 49.00 0% 0% 0.00 DHFSH23470 Lift Lobby Flooring 6.00 16-Feb-15 22-Feb-15 08-Mar-15 14-Mar-15 72.00 0% 0% 0.00 DHFSH23490 Utility Rooms- Epoxy Flooring 6.00 23-Feb-15 01-Mar-15 15-Mar-15 21-Mar-15 72.00 0% 0% 0.00 Staircase 127.00 23-Sep-14 18-May-15 21-Oct-14 21-Mar-15 77.00 45.08% 0% 0.00 DHFSH23200 Staircase Plastering 4.00 23-Sep-14 27-Sep-14 21-Oct-14 26-Oct-14 157.00 100% 0% 0.00 DHFSH23280 Staircase Painting - Primer & Stucco 6.00 15-Oct-14 21-Oct-14 11-Nov-14 17-Nov-14 144.00 0% 0% 0.00 DHFSH23320 Staircase Handrail Fixing 3.00 03-Feb-15 07-Feb-15 16-Dec-14 18-Dec-14 140.00 0% 0% 0.00 DHFSH23330 Staircase Painting 1st Coat 3.00 07-Feb-15 10-Feb-15 16-Feb-15 19-Feb-15 91.00 0% 0% 0.00 DHFSH23340 Staircase Final Painting 5.00 10-May-15 14-May-15 14-Mar-15 18-Mar-15 77.00 0% 0% 0.00 DHFSH23380 Staircase Epoxy Flooring 2.00 17-May-15 18-May-15 19-Mar-15 21-Mar-15 77.00 0% 0% 0.00 General 353.00 04-Aug-14 28-Sep-15 04-Aug-14 A 22-Nov-15 -43.00 0% 0% 0.00 DHSTR23000 Access from Structure 0.00 04-Aug-14 04-Aug-14 A 100% 100% 0.00 DHFSH23510 Snagging & De-Snagging 12.00 13-Sep-15 28-Sep-15 09-Nov-15 22-Nov-15 -43.00 0% 0% 0.00 MEP - LEVEL 23 479.00 30-Jun-14 12-Aug-15 27-Jun-14 A 08-Oct-15 -44.00 69.55% 69.9% 1.01 DHMEP23000 Embeded Conduits & Boxex - Concrete Works 3.00 30-Jun-14 02-Jul-14 27-Jun-14 A 04-Jul-14 A 100% 100% 0.00 DHMEP23100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C04a-bAliungg- 1, 4Wiring et2c4-Aug-14 04-Aug-14 A 13-Sep-14 A 100% 100% 1.00 DHMEP23130 Cable Trays & Cable Trunking 6.00 02-Sep-14 08-Sep-14 04-Aug-14 A 13-Sep-14 A 100% 100% 0.00 DHMEP23120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 07-Sep-14 13-Sep-14 11-Sep-14 A 29-Sep-14 A 100% 100% 1.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Marking,Cutting & Chasing - Wet Area Block Work in Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 31 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 76.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHMEP23160 Pressure Testing of Pipes 12.00 14-Sep-14 27-Sep-14 30-Aug-14 A 14-Oct-14 78.00 100% 66% 0.00 DHMEP23110 MEP Works in Risers& Clearance 6.00 26-Oct-14 01-Nov-14 20-Aug-14 A 17-Dec-14 -33.00 0% 12% 0.00 DHMEP23140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es14-Dec-14 20-Dec-14 14-Sep-14 A 04-Feb-15 -11.00 0% 12% 0.00 DHMEP23150 MEP Final Fixes 6.00 29-Jun-15 05-Jul-15 29-Aug-15 03-Sep-15 -41.00 0% 0% 0.00 DHMEP06350 Sanitary ware /Toilet accessories 6.00 02-Jul-15 08-Jul-15 01-Sep-15 07-Sep-15 -26.00 0% 0% 0.00 DHMEP23200 Pre-Testing & Commissioning 7.00 05-Aug-15 12-Aug-15 01-Oct-15 08-Oct-15 -44.00 0% 0% 0.00 LEVEL 24 519.00 22-Jun-14 05-Oct-15 17-Jun-14 A 29-Nov-15 -43.00 69.45% 61.38% 0.88 STRUCTURAL WORKS - LEVEL 24 20.00 22-Jun-14 14-Jul-14 17-Jun-14 A 14-Jul-14 A 100% 100% 1.00 DHCWA25100 Core Wall - Level 24 8.00 22-Jun-14 30-Jun-14 17-Jun-14 A 19-Jun-14 A 100% 100% 1.00 DHSLA24100 Construction of Horizontals - L24 4.00 07-Jul-14 10-Jul-14 04-Jul-14 A 10-Jul-14 A 100% 100% 1.00 DHCWA25110 Construction of Verticals - L24 3.00 12-Jul-14 14-Jul-14 10-Jul-14 A 14-Jul-14 A 100% 100% 1.00 STAIRCASES 4.00 22-Sep-14 25-Sep-14 24-Aug-14 A 30-Aug-14 A 0% 0% 0.00 A1660 Stair # 1 4.00 22-Sep-14 25-Sep-14 24-Aug-14 A 30-Aug-14 A 100% 100% 0.00 A1670 Stair # 2 3.00 23-Sep-14 25-Sep-14 24-Aug-14 A 30-Aug-14 A 100% 100% 0.00 FINISHES WORKS - LEVEL 24 359.00 10-Aug-14 05-Oct-15 10-Aug-14 A 29-Nov-15 -43.00 21.35% 10.88% 0.51 Dry area 331.00 01-Sep-14 08-Sep-15 28-Aug-14 A 09-Nov-15 -38.00 35.49% 24.98% 0.70 DHFSH24120 Marking,Cutting & Chasing - Dry Area 4.00 08-Sep-14 11-Sep-14 11-Sep-14 A 15-Sep-14 A 100% 100% 1.00 DHFSH24100 Block Work in Dry Area 6.00 01-Sep-14 07-Sep-14 28-Aug-14 A 21-Sep-14 A 100% 100% 1.00 DHFSH24130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 13-Sep-14 16-Sep-14 09-Oct-14 13-Oct-14 52.00 100% 0% 0.00 DHFSH24160 Plaster in Dry Area 8.00 20-Sep-14 28-Sep-14 14-Oct-14 22-Oct-14 52.00 100% 0% 0.00 DHMEP24190 Dry Area Floor Screed 7.00 29-Sep-14 08-Oct-14 23-Oct-14 01-Nov-14 52.00 28.57% 0% 0.00 DHFSH24230 Dry Area Painting - Primer 4.00 09-Oct-14 13-Oct-14 02-Nov-14 05-Nov-14 107.00 0% 0% 0.00 DHFSH24260 Dry Area Painting - Stucco 6.00 14-Oct-14 20-Oct-14 06-Nov-14 12-Nov-14 107.00 0% 0% 0.00 DHFSH24290 Dry Area False Ceiling Suspension 6.00 18-Nov-14 25-Nov-14 17-Jan-15 24-Jan-15 -23.00 0% 0% 0.00 DHFSH24350 Dry Area False Ceiling Tiling / Boarding 5.00 24-Dec-14 29-Dec-14 09-Feb-15 15-Feb-15 29.00 0% 0% 0.00 DHFSH24400 Dry Area Painting - 1st Coat 5.00 30-Dec-14 05-Jan-15 15-Feb-15 21-Feb-15 29.00 0% 0% 0.00 DHFSH24450 Dry Area Flooring 5.00 16-Feb-15 21-Feb-15 08-Mar-15 12-Mar-15 16.00 0% 0% 0.00 DHFSH24430 Installation of Timber Doors & Ironmongery 4.00 25-Jun-15 29-Jun-15 25-Aug-15 29-Aug-15 -50.00 0% 0% 0.00 DHFSH24802 Installation of Wardrobe 12.00 05-Aug-15 18-Aug-15 05-Oct-15 19-Oct-15 -50.00 0% 0% 0.00 DHFSH24500 Paint Final Coat 6.00 02-Sep-15 08-Sep-15 03-Nov-15 09-Nov-15 -38.00 0% 0% 0.00 Wet area 325.00 01-Sep-14 01-Sep-15 28-Aug-14 A 02-Nov-15 -50.00 10.35% 1.03% 0.10 DHFSH24140 Marking,Cutting & Chasing - Wet Area 4.00 08-Sep-14 11-Sep-14 11-Sep-14 A 15-Sep-14 A 100% 100% 1.00 DHFSH24110 Block Work in Wet Area 6.00 01-Sep-14 07-Sep-14 28-Aug-14 A 21-Sep-14 A 100% 100% 0.00 DHFSH24150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 13-Sep-14 16-Sep-14 09-Oct-14 13-Oct-14 56.00 100% 0% 0.00 DHMEP24170 Plaster in Wet Area 4.00 20-Sep-14 23-Sep-14 14-Oct-14 18-Oct-14 56.00 100% 0% 0.00 DHMEP24180 Wet Area Wall Tiling 6.00 18-Nov-14 25-Nov-14 24-Dec-14 30-Dec-14 1.00 0% 0% 0.00 DHFSH24300 Wet Area False Ceiling Suspension 5.00 25-Nov-14 01-Dec-14 24-Jan-15 29-Jan-15 -12.00 0% 0% 0.00 DHFSH24370 Wet Area False Ceiling Tiling/Boarding 4.00 24-Dec-14 28-Dec-14 09-Feb-15 14-Feb-15 7.00 0% 0% 0.00 DHFSH24210 Wet Area Waterproofing 4.00 29-Dec-14 03-Jan-15 14-Feb-15 18-Feb-15 7.00 0% 0% 0.00 DHFSH24220 Wet Area Floor Screed 4.00 04-Jan-15 07-Jan-15 18-Feb-15 23-Feb-15 7.00 0% 0% 0.00 DHFSH24250 Wet Area Floor Tiling 5.00 08-Jan-15 13-Jan-15 23-Feb-15 01-Mar-15 7.00 0% 0% 0.00 DHFSH06680 Cabinet Carcass 5.00 18-Feb-15 23-Feb-15 10-Mar-15 15-Mar-15 -1.00 0% 0% 0.00 DHFSH24420 Installation of Shower Enclosure 4.00 29-Jun-15 02-Jul-15 29-Aug-15 01-Sep-15 -42.00 0% 0% 0.00 DHFSH24390 Installation of Vanity Counters & Tops 5.00 01-Jul-15 06-Jul-15 31-Aug-15 05-Sep-15 -50.00 0% 0% 0.00 DHFSH24800 Installation of Kitchen Cabinet 12.00 19-Aug-15 01-Sep-15 20-Oct-15 02-Nov-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 123.00 09-Oct-14 12-May-15 02-Nov-14 26-Mar-15 69.00 0% 0% 0.00 DHFSH24240 Corridor/Lift Lobby Floor Screed 4.00 09-Oct-14 13-Oct-14 02-Nov-14 05-Nov-14 52.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - Level 24 Construction of Horizontals - L24 Construction of Verticals - L24 Stair # 1 Stair # 2 Marking,Cutting & Chasing - Dry Area Block Work in Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Marking,Cutting & Chasing - Wet Area Block Work in Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 32 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 77.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH24270 Lift Lobby Painting - Primer & Stucco 6.00 14-Oct-14 20-Oct-14 06-Nov-14 12-Nov-14 52.00 0% 0% 0.00 DHFSH24310 Lift Lobby False Ceiling Suspension 6.00 01-Dec-14 09-Dec-14 29-Jan-15 05-Feb-15 -12.00 0% 0% 0.00 DHFSH24360 Lift Lobby False Ceiling Tiling / Boarding 5.00 24-Dec-14 29-Dec-14 09-Feb-15 15-Feb-15 82.00 0% 0% 0.00 DHFSH24410 Lift Lobby Painting - 1st Coat 6.00 30-Dec-14 06-Jan-15 15-Feb-15 22-Feb-15 82.00 0% 0% 0.00 DHFSH24440 Installation of Steel Doors & Windows 3.00 10-May-15 12-May-15 16-Mar-15 18-Mar-15 47.00 0% 0% 0.00 DHFSH24470 Lift Lobby Flooring 6.00 22-Feb-15 28-Feb-15 14-Mar-15 19-Mar-15 69.00 0% 0% 0.00 DHFSH24490 Utility Rooms- Epoxy Flooring 6.00 01-Mar-15 07-Mar-15 21-Mar-15 26-Mar-15 69.00 0% 0% 0.00 Staircase 130.00 29-Sep-14 21-May-15 23-Oct-14 26-Mar-15 76.00 22.54% 0% 0.00 DHFSH24200 Staircase Plastering 4.00 29-Sep-14 02-Oct-14 23-Oct-14 28-Oct-14 158.00 50% 0% 0.00 DHFSH24280 Staircase Painting - Primer & Stucco 6.00 21-Oct-14 28-Oct-14 13-Nov-14 19-Nov-14 145.00 0% 0% 0.00 DHFSH24320 Staircase Handrail Fixing 3.00 07-Feb-15 10-Feb-15 20-Dec-14 22-Dec-14 140.00 0% 0% 0.00 DHFSH24330 Staircase Painting 1st Coat 3.00 10-Feb-15 14-Feb-15 21-Feb-15 24-Feb-15 90.00 0% 0% 0.00 DHFSH24340 Staircase Final Painting 5.00 13-May-15 19-May-15 19-Mar-15 24-Mar-15 76.00 0% 0% 0.00 DHFSH24380 Staircase Epoxy Flooring 2.00 20-May-15 21-May-15 25-Mar-15 26-Mar-15 76.00 0% 0% 0.00 General 359.00 10-Aug-14 05-Oct-15 10-Aug-14 A 29-Nov-15 -43.00 0% 0% 0.00 DHSTR24000 Access from Structure 0.00 10-Aug-14 10-Aug-14 A 100% 100% 0.00 DHFSH24510 Snagging & De-Snagging 12.00 20-Sep-15 05-Oct-15 16-Nov-15 29-Nov-15 -43.00 0% 0% 0.00 MEP - LEVEL 24 482.00 08-Jul-14 19-Aug-15 04-Jul-14 A 17-Oct-15 -44.00 69.55% 55.73% 0.80 DHMEP24000 Embeded Conduits & Boxex - Concrete Works 3.00 08-Jul-14 10-Jul-14 04-Jul-14 A 10-Jul-14 A 100% 100% 0.00 DHMEP24100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C10a-bAliungg- 1, 4Wiring et3c0-Aug-14 10-Aug-14 A 14-Sep-14 A 100% 100% 1.00 DHMEP24130 Cable Trays & Cable Trunking 6.00 08-Sep-14 14-Sep-14 10-Aug-14 A 14-Sep-14 A 100% 100% 0.00 DHMEP24120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 13-Sep-14 18-Sep-14 16-Sep-14 A 12-Oct-14 53.00 100% 59% 0.59 DHMEP24160 Pressure Testing of Pipes 12.00 20-Sep-14 02-Oct-14 30-Aug-14 A 18-Oct-14 78.00 83.33% 66% 0.00 DHMEP24110 MEP Works in Risers& Clearance 6.00 02-Nov-14 08-Nov-14 24-Aug-14 A 23-Dec-14 -33.00 0% 12% 0.00 DHMEP24140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es17-Dec-14 23-Dec-14 16-Sep-14 A 09-Feb-15 -12.00 0% 12% 0.00 DHMEP24150 MEP Final Fixes 6.00 04-Jul-15 09-Jul-15 02-Sep-15 08-Sep-15 -42.00 0% 0% 0.00 DHMEP06360 Sanitary ware /Toilet accessories 6.00 07-Jul-15 13-Jul-15 06-Sep-15 12-Sep-15 -24.00 0% 0% 0.00 DHMEP24200 Pre-Testing & Commissioning 7.00 12-Aug-15 19-Aug-15 08-Oct-15 17-Oct-15 -44.00 0% 0% 0.00 LEVEL 25 534.00 01-Jul-14 12-Oct-15 21-Jun-14 A 07-Dec-15 -43.00 68.79% 52.75% 0.77 STRUCTURAL WORKS - LEVEL 25 18.00 01-Jul-14 21-Jul-14 21-Jun-14 A 19-Jul-14 A 100% 100% 1.00 DHCWA26100 Core Wall - Level 25 5.00 01-Jul-14 06-Jul-14 21-Jun-14 A 26-Jun-14 A 100% 100% 1.00 DHSLA25100 Construction of Horizontals - L25 4.00 15-Jul-14 19-Jul-14 10-Jul-14 A 17-Jul-14 A 100% 100% 1.00 DHCWA26110 Construction of Verticals - L25 2.00 20-Jul-14 21-Jul-14 17-Jul-14 A 19-Jul-14 A 100% 100% 1.00 STAIRCASES 4.00 28-Sep-14 01-Oct-14 01-Sep-14 A 04-Sep-14 A 0% 0% 0.00 A1680 Stair # 1 4.00 28-Sep-14 01-Oct-14 01-Sep-14 A 04-Sep-14 A 75% 100% 0.00 A1690 Stair # 2 3.00 29-Sep-14 01-Oct-14 01-Sep-14 A 04-Sep-14 A 66.67% 100% 0.00 FINISHES WORKS - LEVEL 25 365.00 17-Aug-14 12-Oct-15 13-Aug-14 A 07-Dec-15 -43.00 18.36% 9.92% 0.54 Dry area 337.00 07-Sep-14 15-Sep-15 30-Aug-14 A 16-Nov-15 -38.00 32.42% 23.82% 0.73 DHFSH25100 Block Work in Dry Area 6.00 07-Sep-14 13-Sep-14 30-Aug-14 A 27-Sep-14 A 100% 100% 1.00 DHFSH25120 Marking,Cutting & Chasing - Dry Area 4.00 14-Sep-14 17-Sep-14 09-Oct-14 13-Oct-14 50.00 100% 0% 0.00 DHFSH25130 Sub frame Fixing/Plaster Preparation - Dry Area 5.00 18-Sep-14 23-Sep-14 14-Oct-14 19-Oct-14 51.00 100% 0% 0.00 DHFSH25160 Plaster in Dry Area 8.00 25-Sep-14 06-Oct-14 21-Oct-14 30-Oct-14 50.00 62.5% 0% 0.00 DHMEP25190 Dry Area Floor Screed 7.00 07-Oct-14 14-Oct-14 01-Nov-14 08-Nov-14 50.00 0% 0% 0.00 DHFSH25230 Dry Area Painting - Primer 4.00 15-Oct-14 19-Oct-14 09-Nov-14 12-Nov-14 106.00 0% 0% 0.00 DHFSH25260 Dry Area Painting - Stucco 6.00 20-Oct-14 27-Oct-14 13-Nov-14 19-Nov-14 106.00 0% 0% 0.00 DHFSH25290 Dry Area False Ceiling Suspension 6.00 23-Nov-14 30-Nov-14 21-Jan-15 28-Jan-15 -23.00 0% 0% 0.00 DHFSH25350 Dry Area False Ceiling Tiling / Boarding 5.00 31-Dec-14 06-Jan-15 16-Feb-15 22-Feb-15 28.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - Level 25 Construction of Horizontals - L25 Construction of Verticals - L25 Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 33 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 78.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH25400 Dry Area Painting - 1st Coat 5.00 07-Jan-15 12-Jan-15 22-Feb-15 28-Feb-15 28.00 0% 0% 0.00 DHFSH25450 Dry Area Flooring 5.00 22-Feb-15 26-Feb-15 14-Mar-15 18-Mar-15 16.00 0% 0% 0.00 DHFSH25430 Installation of Timber Doors & Ironmongery 4.00 30-Jun-15 04-Jul-15 30-Aug-15 02-Sep-15 -50.00 0% 0% 0.00 DHFSH25802 Installation of Wardrobe 12.00 12-Aug-15 25-Aug-15 12-Oct-15 26-Oct-15 -50.00 0% 0% 0.00 DHFSH25500 Paint Final Coat 6.00 09-Sep-15 15-Sep-15 10-Nov-15 16-Nov-15 -38.00 0% 0% 0.00 Wet area 331.00 07-Sep-14 08-Sep-15 30-Aug-14 A 09-Nov-15 -50.00 10.35% 0% 0.00 DHFSH25110 Block Work in Wet Area 6.00 07-Sep-14 13-Sep-14 30-Aug-14 A 27-Sep-14 A 100% 100% 0.00 DHFSH25140 Marking,Cutting & Chasing - Wet Area 4.00 14-Sep-14 17-Sep-14 09-Oct-14 13-Oct-14 50.00 100% 0% 0.00 DHFSH25150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 18-Sep-14 22-Sep-14 14-Oct-14 18-Oct-14 56.00 100% 0% 0.00 DHMEP25170 Plaster in Wet Area 4.00 25-Sep-14 29-Sep-14 21-Oct-14 26-Oct-14 54.00 100% 0% 0.00 DHMEP25180 Wet Area Wall Tiling 6.00 23-Nov-14 30-Nov-14 29-Dec-14 05-Jan-15 1.00 0% 0% 0.00 DHFSH25300 Wet Area False Ceiling Suspension 5.00 30-Nov-14 07-Dec-14 28-Jan-15 03-Feb-15 -12.00 0% 0% 0.00 DHFSH25370 Wet Area False Ceiling Tiling/Boarding 4.00 31-Dec-14 05-Jan-15 16-Feb-15 21-Feb-15 6.00 0% 0% 0.00 DHFSH25210 Wet Area Waterproofing 4.00 06-Jan-15 10-Jan-15 21-Feb-15 25-Feb-15 6.00 0% 0% 0.00 DHFSH25220 Wet Area Floor Screed 4.00 11-Jan-15 14-Jan-15 25-Feb-15 02-Mar-15 6.00 0% 0% 0.00 DHFSH25250 Wet Area Floor Tiling 5.00 15-Jan-15 20-Jan-15 02-Mar-15 08-Mar-15 6.00 0% 0% 0.00 DHFSH06690 Cabinet Carcass 5.00 24-Feb-15 01-Mar-15 16-Mar-15 21-Mar-15 -1.00 0% 0% 0.00 DHFSH25420 Installation of Shower Enclosure 4.00 04-Jul-15 07-Jul-15 02-Sep-15 06-Sep-15 -43.00 0% 0% 0.00 DHFSH25390 Installation of Vanity Counters & Tops 5.00 06-Jul-15 11-Jul-15 05-Sep-15 09-Sep-15 -50.00 0% 0% 0.00 DHFSH25800 Installation of Kitchen Cabinet 12.00 26-Aug-15 08-Sep-15 27-Oct-15 09-Nov-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 122.00 15-Oct-14 17-May-15 09-Nov-14 01-Apr-15 66.00 0% 0% 0.00 DHFSH25240 Corridor/Lift Lobby Floor Screed 4.00 15-Oct-14 19-Oct-14 09-Nov-14 12-Nov-14 50.00 0% 0% 0.00 DHFSH25270 Lift Lobby Painting - Primer & Stucco 6.00 20-Oct-14 27-Oct-14 13-Nov-14 19-Nov-14 50.00 0% 0% 0.00 DHFSH25310 Lift Lobby False Ceiling Suspension 6.00 07-Dec-14 14-Dec-14 03-Feb-15 10-Feb-15 -12.00 0% 0% 0.00 DHFSH25360 Lift Lobby False Ceiling Tiling / Boarding 5.00 31-Dec-14 06-Jan-15 16-Feb-15 22-Feb-15 79.00 0% 0% 0.00 DHFSH25410 Lift Lobby Painting - 1st Coat 6.00 07-Jan-15 13-Jan-15 22-Feb-15 01-Mar-15 79.00 0% 0% 0.00 DHFSH25440 Installation of Steel Doors & Windows 3.00 13-May-15 17-May-15 22-Mar-15 24-Mar-15 45.00 0% 0% 0.00 DHFSH25470 Lift Lobby Flooring 6.00 28-Feb-15 05-Mar-15 19-Mar-15 25-Mar-15 66.00 0% 0% 0.00 DHFSH25490 Utility Rooms- Epoxy Flooring 6.00 07-Mar-15 12-Mar-15 26-Mar-15 01-Apr-15 66.00 0% 0% 0.00 Staircase 129.00 07-Oct-14 25-May-15 01-Nov-14 01-Apr-15 75.00 0% 0% 0.00 DHFSH25200 Staircase Plastering 4.00 07-Oct-14 11-Oct-14 01-Nov-14 04-Nov-14 155.00 0% 0% 0.00 DHFSH25280 Staircase Painting - Primer & Stucco 6.00 28-Oct-14 03-Nov-14 20-Nov-14 26-Nov-14 142.00 0% 0% 0.00 DHFSH25320 Staircase Handrail Fixing 3.00 10-Feb-15 14-Feb-15 23-Dec-14 25-Dec-14 140.00 0% 0% 0.00 DHFSH25330 Staircase Painting 1st Coat 3.00 14-Feb-15 17-Feb-15 28-Feb-15 03-Mar-15 87.00 0% 0% 0.00 DHFSH25340 Staircase Final Painting 5.00 18-May-15 23-May-15 25-Mar-15 30-Mar-15 75.00 0% 0% 0.00 DHFSH25380 Staircase Epoxy Flooring 2.00 24-May-15 25-May-15 31-Mar-15 01-Apr-15 75.00 0% 0% 0.00 General 365.00 17-Aug-14 12-Oct-15 13-Aug-14 A 07-Dec-15 -43.00 0% 0% 0.00 DHSTR25000 Access from Structure 0.00 17-Aug-14 13-Aug-14 A 100% 100% 0.00 DHFSH25510 Snagging & De-Snagging 12.00 29-Sep-15 12-Oct-15 23-Nov-15 07-Dec-15 -43.00 0% 0% 0.00 MEP - LEVEL 25 494.00 16-Jul-14 23-Aug-15 10-Jul-14 A 20-Oct-15 -44.00 69.55% 35.09% 0.50 DHMEP25000 Embeded Conduits & Boxex - Concrete Works 3.00 16-Jul-14 19-Jul-14 10-Jul-14 A 17-Jul-14 A 100% 100% 0.00 DHMEP25100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C17a-bAliungg- 1, 4Wiring et0c6-Sep-14 13-Aug-14 A 18-Sep-14 A 100% 100% 1.00 DHMEP25130 Cable Trays & Cable Trunking 6.00 14-Sep-14 20-Sep-14 13-Aug-14 A 18-Sep-14 A 100% 100% 0.00 DHMEP25120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 18-Sep-14 24-Sep-14 14-Oct-14 20-Oct-14 50.00 100% 0% 0.00 DHMEP25160 Pressure Testing of Pipes 12.00 25-Sep-14 11-Oct-14 09-Sep-14 A 30-Oct-14 74.00 41.67% 33% 0.00 DHMEP25110 MEP Works in Risers& Clearance 6.00 09-Nov-14 15-Nov-14 30-Aug-14 A 29-Dec-14 -33.00 0% 12% 0.00 DHMEP25140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es24-Dec-14 30-Dec-14 17-Sep-14 A 16-Feb-15 -12.00 0% 4% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 34 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 79.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHMEP25150 MEP Final Fixes 6.00 08-Jul-15 14-Jul-15 07-Sep-15 13-Sep-15 -43.00 0% 0% 0.00 DHMEP06370 Sanitary ware /Toilet accessories 6.00 12-Jul-15 20-Jul-15 10-Sep-15 16-Sep-15 -25.00 0% 0% 0.00 DHMEP25200 Pre-Testing & Commissioning 7.00 16-Aug-15 23-Aug-15 12-Oct-15 20-Oct-15 -44.00 0% 0% 0.00 LEVEL 26 540.00 07-Jul-14 20-Oct-15 27-Jun-14 A 14-Dec-15 -43.00 65.18% 52.74% 0.81 STRUCTURAL WORKS - LEVEL 26 19.00 07-Jul-14 30-Jul-14 27-Jun-14 A 26-Jul-14 A 100% 100% 1.00 DHCWA27100 Core Wall - Level 26 6.00 07-Jul-14 13-Jul-14 27-Jun-14 A 03-Jul-14 A 100% 100% 1.00 DHSLA26100 Construction of Horizontals - L26 4.00 22-Jul-14 26-Jul-14 17-Jul-14 A 23-Jul-14 A 100% 100% 1.00 DHCWA27110 Construction of Verticals - L26 2.00 27-Jul-14 30-Jul-14 22-Jul-14 A 26-Jul-14 A 100% 100% 1.00 STAIRCASES 4.00 06-Oct-14 09-Oct-14 05-Sep-14 A 08-Sep-14 A 0% 0% 0.00 A1700 Stair # 1 4.00 06-Oct-14 09-Oct-14 05-Sep-14 A 08-Sep-14 A 0% 100% 0.00 A1710 Stair # 2 3.00 07-Oct-14 09-Oct-14 05-Sep-14 A 08-Sep-14 A 0% 100% 0.00 FINISHES WORKS - LEVEL 26 371.00 24-Aug-14 20-Oct-15 19-Aug-14 A 14-Dec-15 -43.00 12.81% 9.92% 0.77 Dry area 343.00 14-Sep-14 22-Sep-15 08-Sep-14 A 23-Nov-15 -38.00 27.29% 23.82% 0.87 DHFSH26100 Block Work in Dry Area 6.00 14-Sep-14 20-Sep-14 08-Sep-14 A 29-Sep-14 A 100% 100% 1.00 DHFSH26120 Marking,Cutting & Chasing - Dry Area 4.00 21-Sep-14 24-Sep-14 09-Oct-14 13-Oct-14 53.00 100% 0% 0.00 DHFSH26130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 25-Sep-14 29-Sep-14 14-Oct-14 18-Oct-14 55.00 100% 0% 0.00 DHFSH26160 Plaster in Dry Area 8.00 02-Oct-14 13-Oct-14 21-Oct-14 30-Oct-14 53.00 0% 0% 0.00 DHMEP26190 Dry Area Floor Screed 7.00 14-Oct-14 21-Oct-14 01-Nov-14 08-Nov-14 53.00 0% 0% 0.00 DHFSH26230 Dry Area Painting - Primer 4.00 22-Oct-14 27-Oct-14 09-Nov-14 12-Nov-14 109.00 0% 0% 0.00 DHFSH26260 Dry Area Painting - Stucco 6.00 28-Oct-14 03-Nov-14 13-Nov-14 19-Nov-14 109.00 0% 0% 0.00 DHFSH26290 Dry Area False Ceiling Suspension 6.00 27-Nov-14 06-Dec-14 26-Jan-15 02-Feb-15 -23.00 0% 0% 0.00 DHFSH26350 Dry Area False Ceiling Tiling / Boarding 5.00 05-Jan-15 10-Jan-15 19-Feb-15 25-Feb-15 28.00 0% 0% 0.00 DHFSH26400 Dry Area Painting - 1st Coat 5.00 11-Jan-15 15-Jan-15 25-Feb-15 03-Mar-15 28.00 0% 0% 0.00 DHFSH26450 Dry Area Flooring 5.00 28-Feb-15 04-Mar-15 19-Mar-15 24-Mar-15 16.00 0% 0% 0.00 DHFSH26430 Installation of Timber Doors & Ironmongery 4.00 05-Jul-15 08-Jul-15 03-Sep-15 07-Sep-15 -50.00 0% 0% 0.00 DHFSH26802 Installation of Wardrobe 12.00 19-Aug-15 01-Sep-15 20-Oct-15 02-Nov-15 -50.00 0% 0% 0.00 DHFSH26500 Paint Final Coat 6.00 16-Sep-15 22-Sep-15 17-Nov-15 23-Nov-15 -38.00 0% 0% 0.00 Wet area 337.00 14-Sep-14 15-Sep-15 08-Sep-14 A 16-Nov-15 -50.00 3.08% 0% 0.00 DHFSH26110 Block Work in Wet Area 6.00 14-Sep-14 20-Sep-14 08-Sep-14 A 29-Sep-14 A 100% 100% 0.00 DHFSH26140 Marking,Cutting & Chasing - Wet Area 4.00 21-Sep-14 24-Sep-14 09-Oct-14 13-Oct-14 53.00 100% 0% 0.00 DHFSH26150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 25-Sep-14 29-Sep-14 14-Oct-14 18-Oct-14 60.00 100% 0% 0.00 DHMEP26170 Plaster in Wet Area 4.00 02-Oct-14 08-Oct-14 21-Oct-14 26-Oct-14 58.00 0% 0% 0.00 DHMEP26180 Wet Area Wall Tiling 6.00 27-Nov-14 06-Dec-14 04-Jan-15 10-Jan-15 1.00 0% 0% 0.00 DHFSH26300 Wet Area False Ceiling Suspension 5.00 06-Dec-14 11-Dec-14 02-Feb-15 08-Feb-15 -13.00 0% 0% 0.00 DHFSH26370 Wet Area False Ceiling Tiling/Boarding 4.00 05-Jan-15 08-Jan-15 19-Feb-15 24-Feb-15 8.00 0% 0% 0.00 DHFSH26210 Wet Area Waterproofing 4.00 10-Jan-15 13-Jan-15 24-Feb-15 01-Mar-15 8.00 0% 0% 0.00 DHFSH26220 Wet Area Floor Screed 4.00 14-Jan-15 18-Jan-15 01-Mar-15 05-Mar-15 8.00 0% 0% 0.00 DHFSH26250 Wet Area Floor Tiling 5.00 19-Jan-15 24-Jan-15 05-Mar-15 11-Mar-15 8.00 0% 0% 0.00 DHFSH06700 Cabinet Carcass 5.00 02-Mar-15 07-Mar-15 22-Mar-15 26-Mar-15 -1.00 0% 0% 0.00 DHFSH26420 Installation of Shower Enclosure 4.00 08-Jul-15 12-Jul-15 07-Sep-15 10-Sep-15 -44.00 0% 0% 0.00 DHFSH26390 Installation of Vanity Counters & Tops 5.00 11-Jul-15 15-Jul-15 09-Sep-15 14-Sep-15 -50.00 0% 0% 0.00 DHFSH26800 Installation of Kitchen Cabinet 12.00 02-Sep-15 15-Sep-15 03-Nov-15 16-Nov-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 127.00 22-Oct-14 20-May-15 09-Nov-14 07-Apr-15 63.00 0% 0% 0.00 DHFSH26240 Corridor/Lift Lobby Floor Screed 4.00 22-Oct-14 27-Oct-14 09-Nov-14 12-Nov-14 53.00 0% 0% 0.00 DHFSH26270 Lift Lobby Painting - Primer & Stucco 6.00 28-Oct-14 03-Nov-14 13-Nov-14 19-Nov-14 53.00 0% 0% 0.00 DHFSH26310 Lift Lobby False Ceiling Suspension 6.00 11-Dec-14 18-Dec-14 08-Feb-15 15-Feb-15 -13.00 0% 0% 0.00 DHFSH26360 Lift Lobby False Ceiling Tiling / Boarding 5.00 05-Jan-15 10-Jan-15 19-Feb-15 25-Feb-15 79.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - Level 26 Construction of Horizontals - L26 Construction of Verticals - L26 Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 35 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 80.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH26410 Lift Lobby Painting - 1st Coat 6.00 11-Jan-15 17-Jan-15 25-Feb-15 04-Mar-15 79.00 0% 0% 0.00 DHFSH26440 Installation of Steel Doors & Windows 3.00 18-May-15 20-May-15 28-Mar-15 30-Mar-15 43.00 0% 0% 0.00 DHFSH26470 Lift Lobby Flooring 6.00 05-Mar-15 11-Mar-15 25-Mar-15 31-Mar-15 63.00 0% 0% 0.00 DHFSH26490 Utility Rooms- Epoxy Flooring 6.00 12-Mar-15 18-Mar-15 01-Apr-15 07-Apr-15 63.00 0% 0% 0.00 Staircase 134.00 14-Oct-14 28-May-15 01-Nov-14 07-Apr-15 74.00 0% 0% 0.00 DHFSH26200 Staircase Plastering 4.00 14-Oct-14 18-Oct-14 01-Nov-14 04-Nov-14 158.00 0% 0% 0.00 DHFSH26280 Staircase Painting - Primer & Stucco 6.00 04-Nov-14 10-Nov-14 20-Nov-14 26-Nov-14 145.00 0% 0% 0.00 DHFSH26320 Staircase Handrail Fixing 3.00 14-Feb-15 17-Feb-15 27-Dec-14 29-Dec-14 140.00 0% 0% 0.00 DHFSH26330 Staircase Painting 1st Coat 3.00 17-Feb-15 21-Feb-15 03-Mar-15 07-Mar-15 87.00 0% 0% 0.00 DHFSH26340 Staircase Final Painting 5.00 21-May-15 26-May-15 31-Mar-15 05-Apr-15 74.00 0% 0% 0.00 DHFSH26380 Staircase Epoxy Flooring 2.00 27-May-15 28-May-15 06-Apr-15 07-Apr-15 74.00 0% 0% 0.00 General 371.00 24-Aug-14 20-Oct-15 19-Aug-14 A 14-Dec-15 -43.00 0% 0% 0.00 DHSTR26000 Access from Structure 0.00 24-Aug-14 19-Aug-14 A 100% 100% 0.00 DHFSH26510 Snagging & De-Snagging 12.00 06-Oct-15 20-Oct-15 30-Nov-15 14-Dec-15 -43.00 0% 0% 0.00 MEP - LEVEL 26 535.00 23-Jul-14 26-Aug-15 17-Jul-14 A 08-Dec-15 -82.00 63.79% 35% 0.55 DHMEP26000 Embeded Conduits & Boxex - Concrete Works 3.00 23-Jul-14 26-Jul-14 17-Jul-14 A 23-Jul-14 A 100% 100% 0.00 DHMEP26100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C24a-bAliungg- 1, 4Wiring et1c3-Sep-14 19-Aug-14 A 21-Sep-14 A 100% 100% 1.00 DHMEP26130 Cable Trays & Cable Trunking 6.00 21-Sep-14 27-Sep-14 19-Aug-14 A 21-Sep-14 A 100% 100% 0.00 DHMEP26120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 25-Sep-14 01-Oct-14 14-Oct-14 20-Oct-14 53.00 83.33% 0% 0.00 DHMEP26160 Pressure Testing of Pipes 8.00 02-Oct-14 18-Oct-14 16-Sep-14 A 30-Oct-14 77.00 0% 33% 0.00 DHMEP26110 MEP Works in Risers& Clearance 6.00 16-Nov-14 22-Nov-14 08-Sep-14 A 05-Jan-15 -33.00 0% 12% 0.00 DHMEP26140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es28-Dec-14 04-Jan-15 20-Sep-14 A 19-Feb-15 -12.00 0% 1% 0.00 DHMEP26150 MEP Final Fixes 6.00 13-Jul-15 21-Jul-15 12-Sep-15 17-Sep-15 -44.00 0% 0% 0.00 DHMEP06380 Sanitary ware /Toilet accessories 6.00 16-Jul-15 25-Jul-15 15-Sep-15 21-Sep-15 -26.00 0% 0% 0.00 DHMEP26200 Pre-Testing & Commissioning 7.00 19-Aug-15 26-Aug-15 17-Oct-15 24-Oct-15 -44.00 0% 0% 0.00 DHMEP26010 Busbar - L26 to L30 20.00 21-May-15 13-Jun-15 15-Nov-15 08-Dec-15 -144.00 0% 0% 0.00 LEVEL 27 543.00 14-Jul-14 27-Oct-15 04-Jul-14 A 21-Dec-15 -43.00 52.87% 52.22% 0.99 STRUCTURAL WORKS - LEVEL 27 61.00 14-Jul-14 05-Aug-14 04-Jul-14 A 05-Aug-14 A 100% 100% 1.00 DHCWA28100 Core Wall - L27 6.00 14-Jul-14 20-Jul-14 04-Jul-14 A 14-Jul-14 A 100% 100% 1.00 DHCWA28120 Tower Crane Jump 1.00 20-Jul-14 20-Jul-14 15-Jul-14 A 17-Jul-14 A 100% 100% 0.00 DHSLA27100 Construction of Horizontals - L27 3.00 31-Jul-14 03-Aug-14 27-Jul-14 A 31-Jul-14 A 100% 100% 1.00 DHCWA28110 Construction of Verticals - L27 2.00 04-Aug-14 05-Aug-14 04-Aug-14 A 05-Aug-14 A 100% 100% 1.00 STAIRCASES 4.00 11-Oct-14 14-Oct-14 09-Sep-14 A 14-Sep-14 A 0% 0% 0.00 A1720 Stair # 1 4.00 11-Oct-14 14-Oct-14 09-Sep-14 A 14-Sep-14 A 0% 100% 0.00 A1730 Stair # 2 3.00 11-Oct-14 13-Oct-14 09-Sep-14 A 14-Sep-14 A 0% 100% 0.00 FINISHES WORKS - LEVEL 27 377.00 01-Sep-14 27-Oct-15 04-Sep-14 A 21-Dec-15 -43.00 10.4% 6.94% 0.67 Dry area 346.00 22-Sep-14 01-Oct-15 25-Sep-14 A 30-Nov-15 -38.00 24.4% 16.67% 0.68 DHFSH27100 Block Work in Dry Area 6.00 22-Sep-14 28-Sep-14 25-Sep-14 A 12-Oct-14 3.00 100% 70% 0.70 DHFSH27120 Marking,Cutting & Chasing - Dry Area 4.00 29-Sep-14 02-Oct-14 13-Oct-14 16-Oct-14 53.00 50% 0% 0.00 DHFSH27130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 06-Oct-14 09-Oct-14 18-Oct-14 21-Oct-14 55.00 0% 0% 0.00 DHFSH27160 Plaster in Dry Area 8.00 13-Oct-14 21-Oct-14 26-Oct-14 03-Nov-14 53.00 0% 0% 0.00 DHMEP27190 Dry Area Floor Screed 7.00 22-Oct-14 30-Oct-14 04-Nov-14 11-Nov-14 53.00 0% 0% 0.00 DHFSH27230 Dry Area Painting - Primer 4.00 01-Nov-14 04-Nov-14 12-Nov-14 16-Nov-14 109.00 0% 0% 0.00 DHFSH27260 Dry Area Painting - Stucco 6.00 05-Nov-14 11-Nov-14 17-Nov-14 23-Nov-14 109.00 0% 0% 0.00 DHFSH27290 Dry Area False Ceiling Suspension 6.00 03-Dec-14 10-Dec-14 31-Jan-15 07-Feb-15 -23.00 0% 0% 0.00 DHFSH27350 Dry Area False Ceiling Tiling / Boarding 5.00 08-Jan-15 13-Jan-15 23-Feb-15 01-Mar-15 28.00 0% 0% 0.00 DHFSH27400 Dry Area Painting - 1st Coat 5.00 14-Jan-15 19-Jan-15 01-Mar-15 07-Mar-15 28.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Busbar - L26 to L30 Core Wall - L27 Tower Crane Jump Construction of Horizontals - L27 Construction of Verticals - L27 Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 36 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 81.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH27450 Dry Area Flooring 5.00 05-Mar-15 10-Mar-15 25-Mar-15 30-Mar-15 16.00 0% 0% 0.00 DHFSH27430 Installation of Timber Doors & Ironmongery 4.00 09-Jul-15 13-Jul-15 08-Sep-15 12-Sep-15 -50.00 0% 0% 0.00 DHFSH27802 Installation of Wardrobe 12.00 26-Aug-15 08-Sep-15 27-Oct-15 09-Nov-15 -50.00 0% 0% 0.00 DHFSH27500 Paint Final Coat 6.00 26-Sep-15 01-Oct-15 24-Nov-15 30-Nov-15 -38.00 0% 0% 0.00 Wet area 340.00 22-Sep-14 22-Sep-15 25-Sep-14 A 23-Nov-15 -50.00 0.52% 0% 0.00 DHFSH27110 Block Work in Wet Area 6.00 22-Sep-14 28-Sep-14 25-Sep-14 A 12-Oct-14 53.00 100% 70% 0.00 DHFSH27140 Marking,Cutting & Chasing - Wet Area 4.00 29-Sep-14 02-Oct-14 13-Oct-14 16-Oct-14 53.00 50% 0% 0.00 DHFSH27150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 06-Oct-14 09-Oct-14 18-Oct-14 21-Oct-14 61.00 0% 0% 0.00 DHMEP27170 Plaster in Wet Area 4.00 13-Oct-14 16-Oct-14 26-Oct-14 29-Oct-14 59.00 0% 0% 0.00 DHMEP27180 Wet Area Wall Tiling 6.00 03-Dec-14 10-Dec-14 08-Jan-15 14-Jan-15 1.00 0% 0% 0.00 DHFSH27300 Wet Area False Ceiling Suspension 5.00 10-Dec-14 16-Dec-14 07-Feb-15 12-Feb-15 -14.00 0% 0% 0.00 DHFSH27370 Wet Area False Ceiling Tiling/Boarding 4.00 08-Jan-15 12-Jan-15 23-Feb-15 28-Feb-15 10.00 0% 0% 0.00 DHFSH27210 Wet Area Waterproofing 4.00 13-Jan-15 17-Jan-15 28-Feb-15 04-Mar-15 10.00 0% 0% 0.00 DHFSH27220 Wet Area Floor Screed 4.00 18-Jan-15 21-Jan-15 04-Mar-15 09-Mar-15 10.00 0% 0% 0.00 DHFSH27250 Wet Area Floor Tiling 5.00 22-Jan-15 27-Jan-15 09-Mar-15 15-Mar-15 10.00 0% 0% 0.00 DHFSH06710 Cabinet Carcass 5.00 08-Mar-15 12-Mar-15 28-Mar-15 01-Apr-15 -1.00 0% 0% 0.00 DHFSH27420 Installation of Shower Enclosure 4.00 13-Jul-15 16-Jul-15 12-Sep-15 15-Sep-15 -45.00 0% 0% 0.00 DHFSH27390 Installation of Vanity Counters & Tops 5.00 15-Jul-15 22-Jul-15 14-Sep-15 19-Sep-15 -50.00 0% 0% 0.00 DHFSH27800 Installation of Kitchen Cabinet 12.00 09-Sep-15 22-Sep-15 10-Nov-15 23-Nov-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 129.00 01-Nov-14 24-May-15 12-Nov-14 13-Apr-15 60.00 0% 0% 0.00 DHFSH27240 Corridor/Lift Lobby Floor Screed 4.00 01-Nov-14 04-Nov-14 12-Nov-14 16-Nov-14 53.00 0% 0% 0.00 DHFSH27270 Lift Lobby Painting - Primer & Stucco 6.00 05-Nov-14 11-Nov-14 17-Nov-14 23-Nov-14 53.00 0% 0% 0.00 DHFSH27310 Lift Lobby False Ceiling Suspension 6.00 16-Dec-14 23-Dec-14 12-Feb-15 19-Feb-15 -14.00 0% 0% 0.00 DHFSH27360 Lift Lobby False Ceiling Tiling / Boarding 5.00 08-Jan-15 13-Jan-15 23-Feb-15 01-Mar-15 79.00 0% 0% 0.00 DHFSH27410 Lift Lobby Painting - 1st Coat 6.00 14-Jan-15 20-Jan-15 01-Mar-15 08-Mar-15 79.00 0% 0% 0.00 DHFSH27440 Installation of Steel Doors & Windows 3.00 21-May-15 24-May-15 02-Apr-15 05-Apr-15 41.00 0% 0% 0.00 DHFSH27470 Lift Lobby Flooring 6.00 11-Mar-15 17-Mar-15 31-Mar-15 06-Apr-15 60.00 0% 0% 0.00 DHFSH27490 Utility Rooms- Epoxy Flooring 6.00 18-Mar-15 24-Mar-15 07-Apr-15 13-Apr-15 60.00 0% 0% 0.00 Staircase 136.00 22-Oct-14 01-Jun-15 04-Nov-14 13-Apr-15 73.00 0% 0% 0.00 DHFSH27200 Staircase Plastering 4.00 22-Oct-14 27-Oct-14 04-Nov-14 08-Nov-14 158.00 0% 0% 0.00 DHFSH27280 Staircase Painting - Primer & Stucco 6.00 12-Nov-14 18-Nov-14 24-Nov-14 30-Nov-14 145.00 0% 0% 0.00 DHFSH27320 Staircase Handrail Fixing 3.00 17-Feb-15 21-Feb-15 30-Dec-14 03-Jan-15 140.00 0% 0% 0.00 DHFSH27330 Staircase Painting 1st Coat 3.00 21-Feb-15 24-Feb-15 07-Mar-15 10-Mar-15 87.00 0% 0% 0.00 DHFSH27340 Staircase Final Painting 5.00 25-May-15 30-May-15 06-Apr-15 11-Apr-15 73.00 0% 0% 0.00 DHFSH27380 Staircase Epoxy Flooring 2.00 31-May-15 01-Jun-15 12-Apr-15 13-Apr-15 73.00 0% 0% 0.00 General 377.00 01-Sep-14 27-Oct-15 04-Sep-14 A 21-Dec-15 -43.00 0% 0% 0.00 DHSTR27000 Access from Structure 0.00 01-Sep-14 04-Sep-14 A 100% 100% 0.00 DHFSH27510 Snagging & De-Snagging 12.00 14-Oct-15 27-Oct-15 08-Dec-15 21-Dec-15 -43.00 0% 0% 0.00 MEP - LEVEL 27 497.00 31-Jul-14 30-Aug-15 27-Jul-14 A 27-Oct-15 -44.00 34.97% 35.32% 1.01 DHMEP27000 Embeded Conduits & Boxex - Concrete Works 3.00 31-Jul-14 03-Aug-14 27-Jul-14 A 31-Jul-14 A 100% 100% 0.00 DHMEP27100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C01a-bSlienpg- 1, 4Wiring et2c1-Sep-14 04-Sep-14 A 23-Sep-14 A 100% 100% 1.00 DHMEP27130 Cable Trays & Cable Trunking 6.00 29-Sep-14 07-Oct-14 04-Sep-14 A 19-Oct-14 62.00 33.33% 0% 0.00 DHMEP27120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 06-Oct-14 12-Oct-14 18-Oct-14 23-Oct-14 53.00 0% 0% 0.00 DHMEP27160 Pressure Testing of Pipes 12.00 13-Oct-14 27-Oct-14 26-Sep-14 A 03-Nov-14 77.00 0% 33% 0.00 DHMEP27110 MEP Works in Risers& Clearance 6.00 23-Nov-14 29-Nov-14 15-Sep-14 A 11-Jan-15 -33.00 0% 12% 0.00 DHMEP27140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es31-Dec-14 07-Jan-15 22-Sep-14 A 23-Feb-15 -12.00 0% 12% 0.00 DHMEP27150 MEP Final Fixes 6.00 20-Jul-15 26-Jul-15 16-Sep-15 22-Sep-15 -45.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 37 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 82.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHMEP06390 Sanitary ware /Toilet accessories 6.00 23-Jul-15 29-Jul-15 20-Sep-15 28-Sep-15 -27.00 0% 0% 0.00 DHMEP27200 Pre-Testing & Commissioning 7.00 23-Aug-15 30-Aug-15 20-Oct-15 27-Oct-15 -44.00 0% 0% 0.00 LEVEL 28 546.00 21-Jul-14 03-Nov-15 15-Jul-14 A 28-Dec-15 -43.00 51.27% 51% 0.99 STRUCTURAL WORKS - LEVEL 28 18.00 21-Jul-14 12-Aug-14 15-Jul-14 A 11-Aug-14 A 100% 100% 1.00 DHCWA29100 Core Wall - L28 6.00 21-Jul-14 27-Jul-14 15-Jul-14 A 21-Jul-14 A 100% 100% 1.00 DHSLA28100 Construction of Horizontals - L28 3.00 06-Aug-14 09-Aug-14 06-Aug-14 A 09-Aug-14 A 100% 100% 1.00 DHCWA29110 Construction of Verticals - L28 3.00 10-Aug-14 12-Aug-14 10-Aug-14 A 11-Aug-14 A 100% 100% 1.00 STAIRCASES 4.00 15-Oct-14 19-Oct-14 18-Oct-14 21-Oct-14 50.00 0% 0% 0.00 A1740 Stair # 1 4.00 15-Oct-14 19-Oct-14 18-Oct-14 21-Oct-14 13.00 0% 0% 0.00 A1750 Stair # 2 3.00 15-Oct-14 18-Oct-14 19-Oct-14 21-Oct-14 50.00 0% 0% 0.00 FINISHES WORKS - LEVEL 28 383.00 07-Sep-14 03-Nov-15 08-Sep-14 A 28-Dec-15 -43.00 3.31% 1.49% 0.45 Dry area 347.00 29-Sep-14 08-Oct-15 25-Sep-14 A 08-Dec-15 -38.00 7.94% 3.57% 0.45 DHFSH28100 Block Work in Dry Area 6.00 29-Sep-14 07-Oct-14 25-Sep-14 A 18-Oct-14 3.00 33.33% 15% 0.45 DHFSH28120 Marking,Cutting & Chasing - Dry Area 4.00 08-Oct-14 12-Oct-14 19-Oct-14 22-Oct-14 51.00 0% 0% 0.00 DHFSH28130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 13-Oct-14 16-Oct-14 23-Oct-14 28-Oct-14 53.00 0% 0% 0.00 DHFSH28160 Plaster in Dry Area 8.00 20-Oct-14 29-Oct-14 01-Nov-14 09-Nov-14 51.00 0% 0% 0.00 DHMEP28190 Dry Area Floor Screed 7.00 30-Oct-14 06-Nov-14 10-Nov-14 17-Nov-14 51.00 0% 0% 0.00 DHFSH28230 Dry Area Painting - Primer 4.00 08-Nov-14 11-Nov-14 18-Nov-14 22-Nov-14 107.00 0% 0% 0.00 DHFSH28260 Dry Area Painting - Stucco 6.00 12-Nov-14 18-Nov-14 23-Nov-14 29-Nov-14 107.00 0% 0% 0.00 DHFSH28290 Dry Area False Ceiling Suspension 6.00 08-Dec-14 15-Dec-14 04-Feb-15 11-Feb-15 -23.00 0% 0% 0.00 DHFSH28350 Dry Area False Ceiling Tiling / Boarding 5.00 12-Jan-15 17-Jan-15 28-Feb-15 05-Mar-15 27.00 0% 0% 0.00 DHFSH28400 Dry Area Painting - 1st Coat 5.00 18-Jan-15 22-Jan-15 05-Mar-15 11-Mar-15 27.00 0% 0% 0.00 DHFSH28450 Dry Area Flooring 5.00 11-Mar-15 16-Mar-15 31-Mar-15 05-Apr-15 16.00 0% 0% 0.00 DHFSH28430 Installation of Timber Doors & Ironmongery 4.00 14-Jul-15 20-Jul-15 13-Sep-15 16-Sep-15 -50.00 0% 0% 0.00 DHFSH28802 Installation of Wardrobe 12.00 02-Sep-15 15-Sep-15 03-Nov-15 16-Nov-15 -50.00 0% 0% 0.00 DHFSH28500 Paint Final Coat 6.00 03-Oct-15 08-Oct-15 01-Dec-15 08-Dec-15 -38.00 0% 0% 0.00 Wet area 341.00 29-Sep-14 01-Oct-15 25-Sep-14 A 30-Nov-15 -50.00 0% 0% 0.00 DHFSH28110 Block Work in Wet Area 6.00 29-Sep-14 07-Oct-14 25-Sep-14 A 18-Oct-14 51.00 33.33% 15% 0.00 DHFSH28140 Marking,Cutting & Chasing - Wet Area 4.00 08-Oct-14 12-Oct-14 19-Oct-14 22-Oct-14 51.00 0% 0% 0.00 DHFSH28150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 13-Oct-14 16-Oct-14 23-Oct-14 28-Oct-14 60.00 0% 0% 0.00 DHMEP28170 Plaster in Wet Area 4.00 20-Oct-14 23-Oct-14 01-Nov-14 04-Nov-14 58.00 0% 0% 0.00 DHMEP28180 Wet Area Wall Tiling 6.00 08-Dec-14 15-Dec-14 13-Jan-15 19-Jan-15 1.00 0% 0% 0.00 DHFSH28300 Wet Area False Ceiling Suspension 5.00 15-Dec-14 21-Dec-14 11-Feb-15 17-Feb-15 -15.00 0% 0% 0.00 DHFSH28370 Wet Area False Ceiling Tiling/Boarding 4.00 12-Jan-15 15-Jan-15 28-Feb-15 04-Mar-15 11.00 0% 0% 0.00 DHFSH28210 Wet Area Waterproofing 4.00 17-Jan-15 20-Jan-15 04-Mar-15 09-Mar-15 11.00 0% 0% 0.00 DHFSH28220 Wet Area Floor Screed 4.00 21-Jan-15 25-Jan-15 09-Mar-15 14-Mar-15 11.00 0% 0% 0.00 DHFSH28250 Wet Area Floor Tiling 5.00 26-Jan-15 31-Jan-15 14-Mar-15 19-Mar-15 11.00 0% 0% 0.00 DHFSH06720 Cabinet Carcass 4.00 14-Mar-15 17-Mar-15 02-Apr-15 06-Apr-15 -1.00 0% 0% 0.00 DHFSH28420 Installation of Shower Enclosure 4.00 20-Jul-15 23-Jul-15 16-Sep-15 20-Sep-15 -46.00 0% 0% 0.00 DHFSH28390 Installation of Vanity Counters & Tops 5.00 22-Jul-15 27-Jul-15 19-Sep-15 26-Sep-15 -50.00 0% 0% 0.00 DHFSH28800 Installation of Kitchen Cabinet 12.00 16-Sep-15 01-Oct-15 17-Nov-15 30-Nov-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 129.00 08-Nov-14 27-May-15 18-Nov-14 19-Apr-15 57.00 0% 0% 0.00 DHFSH28240 Corridor/Lift Lobby Floor Screed 4.00 08-Nov-14 11-Nov-14 18-Nov-14 22-Nov-14 51.00 0% 0% 0.00 DHFSH28270 Lift Lobby Painting - Primer & Stucco 6.00 12-Nov-14 18-Nov-14 23-Nov-14 29-Nov-14 51.00 0% 0% 0.00 DHFSH28310 Lift Lobby False Ceiling Suspension 6.00 21-Dec-14 28-Dec-14 17-Feb-15 24-Feb-15 -15.00 0% 0% 0.00 DHFSH28360 Lift Lobby False Ceiling Tiling / Boarding 5.00 12-Jan-15 17-Jan-15 28-Feb-15 05-Mar-15 78.00 0% 0% 0.00 DHFSH28410 Lift Lobby Painting - 1st Coat 6.00 18-Jan-15 24-Jan-15 05-Mar-15 12-Mar-15 78.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - L28 Construction of Horizontals - L28 Construction of Verticals - L28 Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 38 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 83.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH28440 Installation of Steel Doors & Windows 3.00 25-May-15 27-May-15 07-Apr-15 09-Apr-15 40.00 0% 0% 0.00 DHFSH28470 Lift Lobby Flooring 6.00 17-Mar-15 23-Mar-15 06-Apr-15 12-Apr-15 57.00 0% 0% 0.00 DHFSH28490 Utility Rooms- Epoxy Flooring 6.00 24-Mar-15 30-Mar-15 13-Apr-15 19-Apr-15 57.00 0% 0% 0.00 Staircase 135.00 30-Oct-14 04-Jun-15 10-Nov-14 18-Apr-15 71.00 0% 0% 0.00 DHFSH28200 Staircase Plastering 4.00 30-Oct-14 03-Nov-14 10-Nov-14 13-Nov-14 156.00 0% 0% 0.00 DHFSH28280 Staircase Painting - Primer & Stucco 6.00 19-Nov-14 25-Nov-14 30-Nov-14 07-Dec-14 143.00 0% 0% 0.00 DHFSH28320 Staircase Handrail Fixing 3.00 21-Feb-15 24-Feb-15 04-Jan-15 06-Jan-15 140.00 0% 0% 0.00 DHFSH28330 Staircase Painting 1st Coat 3.00 24-Feb-15 28-Feb-15 10-Mar-15 14-Mar-15 87.00 0% 0% 0.00 DHFSH28340 Staircase Final Painting 5.00 28-May-15 02-Jun-15 11-Apr-15 15-Apr-15 71.00 0% 0% 0.00 DHFSH28380 Staircase Epoxy Flooring 2.00 03-Jun-15 04-Jun-15 16-Apr-15 18-Apr-15 71.00 0% 0% 0.00 General 383.00 07-Sep-14 03-Nov-15 08-Sep-14 A 28-Dec-15 -43.00 0% 0% 0.00 DHSTR28000 Access from Structure 0.00 07-Sep-14 08-Sep-14 A 100% 100% 0.00 DHFSH28510 Snagging & De-Snagging 12.00 21-Oct-15 03-Nov-15 15-Dec-15 28-Dec-15 -43.00 0% 0% 0.00 MEP - LEVEL 28 497.00 06-Aug-14 02-Sep-15 06-Aug-14 A 31-Oct-15 -44.00 34.97% 35.32% 1.01 DHMEP28000 Embeded Conduits & Boxex - Concrete Works 3.00 06-Aug-14 09-Aug-14 06-Aug-14 A 09-Aug-14 A 100% 100% 0.00 DHMEP28100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C08a-bSlienpg- 1, 4Wiring et2c8-Sep-14 08-Sep-14 A 29-Sep-14 A 100% 100% 1.00 DHMEP28130 Cable Trays & Cable Trunking 6.00 08-Oct-14 14-Oct-14 08-Sep-14 A 26-Oct-14 61.00 0% 0% 0.00 DHMEP28120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 13-Oct-14 19-Oct-14 23-Oct-14 30-Oct-14 51.00 0% 0% 0.00 DHMEP28160 Pressure Testing of Pipes 12.00 20-Oct-14 03-Nov-14 29-Sep-14 A 09-Nov-14 75.00 0% 33% 0.00 DHMEP28110 MEP Works in Risers& Clearance 6.00 30-Nov-14 07-Dec-14 21-Sep-14 A 17-Jan-15 -33.00 0% 12% 0.00 DHMEP28140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es05-Jan-15 11-Jan-15 24-Sep-14 A 28-Feb-15 -13.00 0% 12% 0.00 DHMEP28150 MEP Final Fixes 6.00 25-Jul-15 30-Jul-15 21-Sep-15 29-Sep-15 -46.00 0% 0% 0.00 DHMEP06400 Sanitary ware /Toilet accessories 6.00 28-Jul-15 03-Aug-15 27-Sep-15 03-Oct-15 -28.00 0% 0% 0.00 DHMEP28200 Pre-Testing & Commissioning 7.00 26-Aug-15 02-Sep-15 24-Oct-15 31-Oct-15 -44.00 0% 0% 0.00 LEVEL 29 565.00 30-Jul-14 14-Nov-15 22-Jul-14 A 12-Jan-16 -50.00 48.72% 47.32% 0.97 STRUCTURAL WORKS - LEVEL 29 18.00 30-Jul-14 19-Aug-14 22-Jul-14 A 16-Aug-14 A 100% 100% 1.00 DHCWA30100 Core Wall - L29 5.00 30-Jul-14 04-Aug-14 22-Jul-14 A 27-Jul-14 A 100% 100% 1.00 DHSLA29100 Construction of Horizontals - L29 3.00 13-Aug-14 16-Aug-14 12-Aug-14 A 14-Aug-14 A 100% 100% 1.00 DHCWA30110 Construction of Verticals - L29 3.00 17-Aug-14 19-Aug-14 15-Aug-14 A 16-Aug-14 A 100% 100% 1.00 STAIRCASES 4.00 19-Oct-14 23-Oct-14 22-Oct-14 27-Oct-14 50.00 0% 0% 0.00 A1760 Stair # 1 4.00 20-Oct-14 23-Oct-14 22-Oct-14 27-Oct-14 13.00 0% 0% 0.00 A1770 Stair # 2 4.00 19-Oct-14 22-Oct-14 22-Oct-14 27-Oct-14 50.00 0% 0% 0.00 FINISHES WORKS - LEVEL 29 396.00 13-Sep-14 14-Nov-15 14-Sep-14 A 12-Jan-16 -50.00 0% 0.55% 0.00 Dry area 378.00 13-Sep-14 31-Oct-15 25-Sep-14 A 29-Dec-15 -50.00 0% 1.19% 0.00 DHFSH29102 Block Work for Mechanical Portion 8.00 13-Sep-14 21-Sep-14 25-Sep-14 A 12-Oct-14 36.00 100% 5% 0.00 DHFSH29100 Block Work in Dry Area 6.00 08-Oct-14 14-Oct-14 25-Sep-14 A 22-Oct-14 3.00 0% 5% 0.00 DHFSH29120 Marking,Cutting & Chasing - Dry Area 4.00 15-Oct-14 19-Oct-14 23-Oct-14 28-Oct-14 50.00 0% 0% 0.00 DHFSH29130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 20-Oct-14 23-Oct-14 29-Oct-14 02-Nov-14 52.00 0% 0% 0.00 DHFSH29600 Service Area Civil Works 20.00 22-Sep-14 16-Oct-14 13-Oct-14 05-Nov-14 36.00 40% 0% 0.00 DHFSH29160 Plaster in Dry Area 8.00 28-Oct-14 05-Nov-14 05-Nov-14 13-Nov-14 50.00 0% 0% 0.00 DHMEP29190 Dry Area Floor Screed 7.00 06-Nov-14 13-Nov-14 15-Nov-14 22-Nov-14 50.00 0% 0% 0.00 DHFSH29230 Dry Area Painting - Primer 4.00 15-Nov-14 18-Nov-14 23-Nov-14 26-Nov-14 106.00 0% 0% 0.00 DHFSH29260 Dry Area Painting - Stucco 6.00 19-Nov-14 25-Nov-14 27-Nov-14 04-Dec-14 106.00 0% 0% 0.00 DHFSH29290 Dry Area False Ceiling Suspension 6.00 13-Dec-14 20-Dec-14 09-Feb-15 16-Feb-15 -23.00 0% 0% 0.00 DHFSH29350 Dry Area False Ceiling Tiling / Boarding 5.00 19-Jan-15 24-Jan-15 07-Mar-15 12-Mar-15 24.00 0% 0% 0.00 DHFSH29400 Dry Area Painting - 1st Coat 5.00 25-Jan-15 29-Jan-15 12-Mar-15 18-Mar-15 24.00 0% 0% 0.00 DHFSH29450 Dry Area Flooring 5.00 16-Mar-15 21-Mar-15 05-Apr-15 09-Apr-15 16.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - L29 Construction of Horizontals - L29 Construction of Verticals - L29 Stair # 1 Stair # 2 Block Work for Mechanical Portion Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Service Area Civil Works Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 39 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 84.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH29430 Installation of Timber Doors & Ironmongery 5.00 21-Jul-15 26-Jul-15 17-Sep-15 22-Sep-15 -50.00 0% 0% 0.00 DHFSH29802 Installation of Wardrobe 12.00 09-Sep-15 22-Sep-15 10-Nov-15 23-Nov-15 -50.00 0% 0% 0.00 DHFSH29500 Paint Final Coat 6.00 25-Oct-15 31-Oct-15 23-Dec-15 29-Dec-15 -50.00 0% 0% 0.00 Wet area 343.00 08-Oct-14 08-Oct-15 25-Sep-14 A 08-Dec-15 -50.00 0% 0% 0.00 DHFSH29110 Block Work in Wet Area 6.00 08-Oct-14 14-Oct-14 25-Sep-14 A 22-Oct-14 50.00 0% 5% 0.00 DHFSH29140 Marking,Cutting & Chasing - Wet Area 4.00 15-Oct-14 19-Oct-14 23-Oct-14 28-Oct-14 50.00 0% 0% 0.00 DHFSH29150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 20-Oct-14 23-Oct-14 29-Oct-14 02-Nov-14 60.00 0% 0% 0.00 DHMEP29170 Plaster in Wet Area 4.00 28-Oct-14 01-Nov-14 05-Nov-14 09-Nov-14 58.00 0% 0% 0.00 DHMEP29180 Wet Area Wall Tiling 6.00 13-Dec-14 20-Dec-14 18-Jan-15 24-Jan-15 1.00 0% 0% 0.00 DHFSH29300 Wet Area False Ceiling Suspension 5.00 20-Dec-14 25-Dec-14 16-Feb-15 22-Feb-15 -16.00 0% 0% 0.00 DHFSH29370 Wet Area False Ceiling Tiling/Boarding 4.00 19-Jan-15 22-Jan-15 07-Mar-15 11-Mar-15 24.00 0% 0% 0.00 DHFSH29210 Wet Area Waterproofing 4.00 24-Jan-15 27-Jan-15 11-Mar-15 16-Mar-15 24.00 0% 0% 0.00 DHFSH29220 Wet Area Floor Screed 4.00 28-Jan-15 01-Feb-15 16-Mar-15 21-Mar-15 24.00 0% 0% 0.00 DHFSH29250 Wet Area Floor Tiling 5.00 02-Feb-15 07-Feb-15 21-Mar-15 26-Mar-15 24.00 0% 0% 0.00 DHFSH29420 Installation of Shower Enclosure 4.00 26-Jul-15 29-Jul-15 22-Sep-15 28-Sep-15 -48.00 0% 0% 0.00 DHFSH29390 Installation of Vanity Counters & Tops 5.00 27-Jul-15 01-Aug-15 26-Sep-15 30-Sep-15 -50.00 0% 0% 0.00 DHFSH29800 Installation of Kitchen Cabinets 12.00 26-Sep-15 08-Oct-15 24-Nov-15 08-Dec-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 129.00 15-Nov-14 31-May-15 23-Nov-14 23-Apr-15 132.00 0% 0% 0.00 DHFSH29240 Corridor/Lift Lobby Floor Screed 4.00 15-Nov-14 18-Nov-14 23-Nov-14 26-Nov-14 50.00 0% 0% 0.00 DHFSH29270 Lift Lobby Painting - Primer & Stucco 6.00 19-Nov-14 25-Nov-14 27-Nov-14 04-Dec-14 50.00 0% 0% 0.00 DHFSH29310 Lift Lobby False Ceiling Suspension 6.00 25-Dec-14 03-Jan-15 22-Feb-15 01-Mar-15 -16.00 0% 0% 0.00 DHFSH29360 Lift Lobby False Ceiling Tiling / Boarding 5.00 19-Jan-15 24-Jan-15 07-Mar-15 12-Mar-15 79.00 0% 0% 0.00 DHFSH29410 Lift Lobby Painting - 1st Coat 6.00 25-Jan-15 31-Jan-15 12-Mar-15 19-Mar-15 79.00 0% 0% 0.00 DHFSH29440 Installation of Steel Doors & Windows 3.00 28-May-15 31-May-15 11-Apr-15 13-Apr-15 40.00 0% 0% 0.00 DHFSH29470 Lift Lobby Flooring 6.00 22-Mar-15 28-Mar-15 11-Apr-15 16-Apr-15 128.00 0% 0% 0.00 DHFSH29490 Utility Rooms- Epoxy Flooring 6.00 29-Mar-15 04-Apr-15 18-Apr-15 23-Apr-15 132.00 0% 0% 0.00 Staircase 134.00 06-Nov-14 08-Jun-15 15-Nov-14 21-Apr-15 70.00 0% 0% 0.00 DHFSH29200 Staircase Plastering 4.00 06-Nov-14 10-Nov-14 15-Nov-14 18-Nov-14 155.00 0% 0% 0.00 DHFSH29280 Staircase Painting - Primer & Stucco 6.00 26-Nov-14 03-Dec-14 06-Dec-14 11-Dec-14 142.00 0% 0% 0.00 DHFSH29320 Staircase Handrail Fixing 3.00 24-Feb-15 28-Feb-15 07-Jan-15 10-Jan-15 140.00 0% 0% 0.00 DHFSH29330 Staircase Painting 1st Coat 3.00 28-Feb-15 03-Mar-15 18-Mar-15 22-Mar-15 83.00 0% 0% 0.00 DHFSH29340 Staircase Final Painting 5.00 01-Jun-15 06-Jun-15 14-Apr-15 19-Apr-15 67.00 0% 0% 0.00 DHFSH29380 Staircase Epoxy Flooring 2.00 07-Jun-15 08-Jun-15 20-Apr-15 21-Apr-15 70.00 0% 0% 0.00 General 396.00 13-Sep-14 14-Nov-15 14-Sep-14 A 12-Jan-16 -50.00 0% 0% 0.00 DHSTR29000 Access from Structure 0.00 13-Sep-14 14-Sep-14 A 100% 100% 0.00 DHFSH29510 Snagging & De-Snagging 12.00 01-Nov-15 14-Nov-15 30-Dec-15 12-Jan-16 -50.00 0% 0% 0.00 MEP - LEVEL 29 515.00 11-Aug-14 13-Sep-15 12-Aug-14 A 14-Nov-15 -50.00 25.83% 22.23% 0.86 DHMEP29000 Embeded Conduits & Boxex - Concrete Works 6.00 11-Aug-14 17-Aug-14 12-Aug-14 A 14-Aug-14 A 100% 100% 0.00 DHMEP29100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C15a-bSlienpg- 1, 4Wiring et0c7-Oct-14 14-Sep-14 A 11-Oct-14 -5.00 77.78% 66% 0.85 DHMEP29130 Cable Trays & Cable Trunking 6.00 15-Oct-14 21-Oct-14 14-Sep-14 A 30-Oct-14 61.00 0% 0% 0.00 DHMEP29120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 20-Oct-14 27-Oct-14 29-Oct-14 04-Nov-14 50.00 0% 0% 0.00 DHMEP29610 Piping Works 21.00 18-Oct-14 11-Nov-14 06-Nov-14 30-Nov-14 36.00 0% 0% 0.00 DHMEP29160 Pressure Testing of Pipes 12.00 26-Nov-14 10-Dec-14 16-Dec-14 29-Dec-14 39.00 0% 0% 0.00 DHMEP29600 Flushing the Loop upto L 30 45.00 18-Oct-14 10-Dec-14 06-Nov-14 29-Dec-14 37.00 0% 0% 0.00 DHMEP29620 Ducting ,Cabling,Wiring& Connections 30.00 12-Nov-14 17-Dec-14 01-Dec-14 06-Jan-15 37.00 0% 0% 0.00 DHMEP29110 MEP Works in Risers& Clearance 6.00 08-Dec-14 14-Dec-14 23-Sep-14 A 22-Jan-15 -33.00 0% 11% 0.00 DHMEP29140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es12-Jan-15 18-Jan-15 29-Sep-14 A 07-Mar-15 -13.00 0% 11% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Installation of Timber Doors & Ironmongery Installation of Wardrobe Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinets Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Piping Works Pressure Testing of Pipes Flushing the Loop upto L 30 Ducting ,Cabling,Wiring& Connections MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 40 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 85.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHMEP29150 MEP Final Fixes 6.00 02-Aug-15 08-Aug-15 01-Oct-15 07-Oct-15 -50.00 0% 0% 0.00 DHMEP06410 Sanitary ware /Toilet accessories 6.00 05-Aug-15 11-Aug-15 05-Oct-15 11-Oct-15 -32.00 0% 0% 0.00 DHMEP29200 Pre-Testing & Commissioning 7.00 06-Sep-15 13-Sep-15 07-Nov-15 14-Nov-15 -50.00 0% 0% 0.00 LEVELS 30 (MECHANICAL FLOOR) 565.00 05-Aug-14 21-Nov-15 28-Jul-14 A 19-Jan-16 -50.00 51.15% 41.8% 0.82 LEVEL 30 (MECHANICAL FLOOR) 565.00 05-Aug-14 21-Nov-15 28-Jul-14 A 19-Jan-16 -50.00 51.15% 41.8% 0.82 STRUCTURAL WORKS - LEVEL 30 45.00 05-Aug-14 26-Aug-14 28-Jul-14 A 28-Aug-14 A 100% 100% 1.00 DHCWA31100 Core Wall - L30 6.00 05-Aug-14 11-Aug-14 28-Jul-14 A 13-Aug-14 A 100% 100% 1.00 DHCWA31120 Tower Crane Jump 1.00 05-Aug-14 05-Aug-14 20-Aug-14 A 20-Aug-14 A 100% 100% 0.00 DHSLA30100 Construction of Horizontals - L30 (Mech Floor) 3.00 20-Aug-14 23-Aug-14 17-Aug-14 A 22-Aug-14 A 100% 100% 1.00 DHCWA31110 Construction of Verticals - L30 (Mech Floor) 3.00 24-Aug-14 26-Aug-14 23-Aug-14 A 28-Aug-14 A 100% 100% 1.00 STAIRCASES 4.00 26-Oct-14 29-Oct-14 29-Oct-14 02-Nov-14 49.00 0% 0% 0.00 A1780 Stair # 1 4.00 26-Oct-14 29-Oct-14 29-Oct-14 02-Nov-14 12.00 0% 0% 0.00 A1790 Stair # 2 4.00 26-Oct-14 29-Oct-14 29-Oct-14 02-Nov-14 49.00 0% 0% 0.00 FINISHES WORKS - LEVEL 30 396.00 17-Sep-14 21-Nov-15 01-Oct-14 19-Jan-16 -50.00 0% 0% 0.00 Dry area 353.00 22-Sep-14 10-Oct-15 13-Oct-14 09-Dec-15 -27.00 0% 0% 0.00 DHFSH30600 Service Area Civil Works 20.00 22-Sep-14 16-Oct-14 13-Oct-14 05-Nov-14 43.00 40% 0% 0.00 DHFSH30100 Block Work in Dry Area 6.00 19-Oct-14 26-Oct-14 02-Nov-14 08-Nov-14 -5.00 0% 0% 0.00 DHFSH30120 Marking,Cutting & Chasing - Dry Area 4.00 27-Oct-14 30-Oct-14 09-Nov-14 12-Nov-14 43.00 0% 0% 0.00 DHFSH30130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 01-Nov-14 04-Nov-14 13-Nov-14 17-Nov-14 45.00 0% 0% 0.00 DHFSH30160 Plaster in Dry Area 8.00 08-Nov-14 16-Nov-14 20-Nov-14 29-Nov-14 43.00 0% 0% 0.00 DHMEP30190 Dry Area Floor Screed 7.00 17-Nov-14 24-Nov-14 30-Nov-14 08-Dec-14 43.00 0% 0% 0.00 DHFSH30230 Dry Area Painting - Primer 4.00 25-Nov-14 29-Nov-14 09-Dec-14 13-Dec-14 96.00 0% 0% 0.00 DHFSH30260 Dry Area Painting - Stucco 6.00 30-Nov-14 07-Dec-14 14-Dec-14 20-Dec-14 96.00 0% 0% 0.00 DHFSH30290 Dry Area False Ceiling Suspension 6.00 17-Dec-14 24-Dec-14 14-Feb-15 21-Feb-15 -23.00 0% 0% 0.00 DHFSH30610 GRP Lining For the Water Tank 20.00 19-Feb-15 14-Mar-15 19-Apr-15 11-May-15 103.00 0% 0% 0.00 DHFSH30350 Dry Area False Ceiling Tiling / Boarding 5.00 24-Feb-15 01-Mar-15 28-May-15 02-Jun-15 -43.00 0% 0% 0.00 DHFSH30400 Dry Area Painting - 1st Coat 5.00 02-Mar-15 07-Mar-15 03-Jun-15 08-Jun-15 -43.00 0% 0% 0.00 DHFSH30450 Dry Area Polyurethene Abrasion resistant Flooring 5.00 22-Mar-15 26-Mar-15 09-Jun-15 14-Jun-15 -34.00 0% 0% 0.00 DHFSH30620 Ladder for Tank 7.00 28-Mar-15 04-Apr-15 15-Jun-15 22-Jun-15 113.00 0% 0% 0.00 DHFSH30430 Installation of Timber Doors & Ironmongery 5.00 25-Jul-15 29-Jul-15 21-Sep-15 28-Sep-15 -12.00 0% 0% 0.00 DHFSH30500 Paint Final Coat 6.00 04-Oct-15 10-Oct-15 03-Dec-15 09-Dec-15 -50.00 0% 0% 0.00 Lift Lobby / Corridor 167.00 25-Nov-14 03-Jun-15 09-Dec-14 23-Jun-15 83.00 0% 0% 0.00 DHFSH30240 Corridor/Lift Lobby Floor Screed 4.00 25-Nov-14 29-Nov-14 09-Dec-14 13-Dec-14 43.00 0% 0% 0.00 DHFSH30270 Lift Lobby Painting - Primer & Stucco 6.00 30-Nov-14 07-Dec-14 14-Dec-14 20-Dec-14 43.00 0% 0% 0.00 DHFSH30310 Lift Lobby False Ceiling Suspension 6.00 03-Jan-15 10-Jan-15 01-Mar-15 08-Mar-15 -16.00 0% 0% 0.00 DHFSH30360 Lift Lobby False Ceiling Tiling / Boarding 5.00 24-Feb-15 01-Mar-15 28-May-15 02-Jun-15 15.00 0% 0% 0.00 DHFSH30410 Lift Lobby Painting - 1st Coat 6.00 02-Mar-15 08-Mar-15 03-Jun-15 09-Jun-15 15.00 0% 0% 0.00 DHFSH30440 Installation of Steel Doors & Windows 3.00 01-Jun-15 03-Jun-15 09-Jun-15 11-Jun-15 -7.00 0% 0% 0.00 DHFSH30470 Lift Lobby Flooring 6.00 29-Mar-15 04-Apr-15 10-Jun-15 16-Jun-15 83.00 0% 0% 0.00 DHFSH30490 Utility Rooms- Epoxy Flooring 6.00 05-Apr-15 11-Apr-15 17-Jun-15 23-Jun-15 83.00 0% 0% 0.00 Staircase 171.00 17-Nov-14 14-Jun-15 30-Nov-14 20-Jun-15 22.00 0% 0% 0.00 DHFSH30200 Staircase Plastering 4.00 17-Nov-14 20-Nov-14 30-Nov-14 04-Dec-14 145.00 0% 0% 0.00 DHFSH30280 Staircase Painting - Primer & Stucco 6.00 08-Dec-14 14-Dec-14 21-Dec-14 27-Dec-14 132.00 0% 0% 0.00 DHFSH30320 Staircase Handrail Fixing 3.00 28-Feb-15 03-Mar-15 11-Jan-15 13-Jan-15 140.00 0% 0% 0.00 DHFSH30330 Staircase Painting 1st Coat 3.00 03-Mar-15 07-Mar-15 22-Mar-15 25-Mar-15 83.00 0% 0% 0.00 DHFSH30340 Staircase Final Painting 5.00 07-Jun-15 11-Jun-15 13-Jun-15 17-Jun-15 22.00 0% 0% 0.00 DHFSH30380 Staircase Epoxy Flooring 2.00 13-Jun-15 14-Jun-15 18-Jun-15 20-Jun-15 22.00 0% 0% 0.00 General 396.00 17-Sep-14 21-Nov-15 01-Oct-14 19-Jan-16 -50.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - L30 Tower Crane Jump Construction of Horizontals - L30 (Mech Floor) Construction of Verticals - L30 (Mech Floor) Stair # 1 Stair # 2 Service Area Civil Works Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension GRP Lining For the Water Tank Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Polyurethene Abrasion resistant Flooring Ladder for Tank Installation of Timber Doors & Ironmongery Paint Final Coat Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 41 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 86.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHSTR30000 Access from Structure 0.00 17-Sep-14 01-Oct-14 -5.00 100% 0% 0.00 DHFSH30510 Snagging & De-Snagging 12.00 08-Nov-15 21-Nov-15 06-Jan-16 19-Jan-16 -50.00 0% 0% 0.00 MEP - LEVEL 30 515.00 18-Aug-14 20-Sep-15 17-Aug-14 A 21-Nov-15 -41.00 20.3% 0% 0.00 DHMEP30000 Embeded Conduits & Boxex - Concrete Works 6.00 18-Aug-14 24-Aug-14 17-Aug-14 A 22-Aug-14 A 100% 100% 0.00 DHMEP30100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C18a-bSlienpg- 1, 4Wiring et1c1-Oct-14 01-Oct-14 23-Oct-14 -5.00 61.11% 0% 0.00 DHMEP30130 Cable Trays & Cable Trunking 6.00 27-Oct-14 02-Nov-14 09-Nov-14 15-Nov-14 52.00 0% 0% 0.00 DHMEP30120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 01-Nov-14 06-Nov-14 13-Nov-14 19-Nov-14 43.00 0% 0% 0.00 DHMEP30610 Install FAHU's 20.00 21-Dec-14 13-Jan-15 22-Dec-14 14-Jan-15 5.00 0% 0% 0.00 DHMEP30110 MEP Works in Risers& Clearance 6.00 15-Dec-14 21-Dec-14 24-Jan-15 29-Jan-15 -33.00 0% 0% 0.00 DHMEP30630 Flushing 1st Loop - Upto L30 25.00 14-Jan-15 11-Feb-15 15-Jan-15 12-Feb-15 5.00 0% 0% 0.00 DHMEP30620 Ducting ,Cabling,Wiring& Connections 30.00 14-Jan-15 17-Feb-15 15-Jan-15 18-Feb-15 40.00 0% 0% 0.00 DHMEP30160 Pressure Testing of Pipes 12.00 05-Feb-15 18-Feb-15 05-Apr-15 18-Apr-15 -14.00 0% 0% 0.00 DHMEP30600 Installation of Water Tanks ,Pumps,,Extract Fans,Pressurization 4F5a.0n0s 28-Dec-14 18-Feb-15 25-Feb-15 18-Apr-15 -50.00 0% 0% 0.00 DHMEP30140 Chiller Installation & Wiring,Cable Pulling,Plenum Boxes &fire Sp3r0in.0k0lers20-Jan-15 23-Feb-15 22-Apr-15 27-May-15 -43.00 0% 0% 0.00 DHMEP30150 MEP Final Fixes 6.00 05-Aug-15 11-Aug-15 05-Oct-15 11-Oct-15 -17.00 0% 0% 0.00 DHMEP06420 Sanitary ware /Toilet accessories 6.00 09-Aug-15 15-Aug-15 08-Oct-15 15-Oct-15 -17.00 0% 0% 0.00 DHMEP30200 Pre-Testing & Commissioning 7.00 13-Sep-15 20-Sep-15 14-Nov-15 21-Nov-15 -41.00 0% 0% 0.00 LEVELS 31 - 61 599.00 12-Aug-14 26-Jan-16 14-Aug-14 A 07-Mar-16 -32.00 8.37% 7.52% 0.90 LEVEL 31 534.00 12-Aug-14 07-Sep-15 14-Aug-14 A 22-Dec-15 -45.00 42.62% 38.85% 0.91 STRUCTURAL WORKS - LEVEL 31 19.00 12-Aug-14 02-Sep-14 14-Aug-14 A 02-Sep-14 A 100% 100% 1.00 DHCWA32100 Core Wall - L31 6.00 12-Aug-14 18-Aug-14 14-Aug-14 A 17-Aug-14 A 100% 100% 1.00 DHSLA31100 Construction of Horizontals - L31 4.00 27-Aug-14 31-Aug-14 29-Aug-14 A 31-Aug-14 A 100% 100% 1.00 DHCWA32110 Construction of Verticals - L31 2.00 01-Sep-14 02-Sep-14 31-Aug-14 A 02-Sep-14 A 100% 100% 1.00 STAIRCASES 4.00 30-Oct-14 03-Nov-14 04-Nov-14 08-Nov-14 47.00 0% 0% 0.00 A1800 Stair # 1 4.00 30-Oct-14 03-Nov-14 04-Nov-14 08-Nov-14 11.00 0% 0% 0.00 A1810 Stair # 2 3.00 01-Nov-14 03-Nov-14 05-Nov-14 08-Nov-14 47.00 0% 0% 0.00 FINISHES WORKS - LEVEL 31 299.00 22-Sep-14 07-Sep-15 21-Sep-14 A 27-Sep-15 28.00 0% 0% 0.00 Dry area 263.00 19-Oct-14 24-Aug-15 02-Nov-14 10-Sep-15 28.00 0% 0% 0.00 DHFSH31100 Block Work in Dry Area 6.00 19-Oct-14 26-Oct-14 02-Nov-14 08-Nov-14 -5.00 0% 0% 0.00 DHFSH31120 Marking,Cutting & Chasing - Dry Area 4.00 27-Oct-14 30-Oct-14 09-Nov-14 12-Nov-14 46.00 0% 0% 0.00 DHFSH31130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 01-Nov-14 04-Nov-14 13-Nov-14 17-Nov-14 48.00 0% 0% 0.00 DHFSH31160 Plaster in Dry Area 8.00 08-Nov-14 16-Nov-14 20-Nov-14 29-Nov-14 46.00 0% 0% 0.00 DHMEP31190 Dry Area Floor Screed 7.00 17-Nov-14 24-Nov-14 30-Nov-14 08-Dec-14 46.00 0% 0% 0.00 DHFSH31230 Dry Area Painting - Primer 4.00 25-Nov-14 29-Nov-14 09-Dec-14 13-Dec-14 104.00 0% 0% 0.00 DHFSH31260 Dry Area Painting - Stucco 6.00 30-Nov-14 07-Dec-14 14-Dec-14 20-Dec-14 104.00 0% 0% 0.00 DHFSH31290 Dry Area False Ceiling Suspension 6.00 22-Dec-14 29-Dec-14 18-Feb-15 25-Feb-15 -23.00 0% 0% 0.00 DHFSH31350 Dry Area False Ceiling Tiling / Boarding 5.00 05-Mar-15 10-Mar-15 07-Jun-15 11-Jun-15 -43.00 0% 0% 0.00 DHFSH31400 Dry Area Painting - 1st Coat 5.00 11-Mar-15 16-Mar-15 13-Jun-15 17-Jun-15 -43.00 0% 0% 0.00 DHFSH31450 Dry Area Flooring 5.00 26-Mar-15 31-Mar-15 18-Jun-15 23-Jun-15 -38.00 0% 0% 0.00 DHFSH31430 Installation of Timber Doors & Ironmongery 5.00 21-Jul-15 26-Jul-15 06-Aug-15 12-Aug-15 -14.00 0% 0% 0.00 DHFSH31802 Installation of Wardrobe 12.00 22-Jul-15 04-Aug-15 08-Aug-15 22-Aug-15 -14.00 0% 0% 0.00 DHFSH31500 Paint Final Coat 6.00 18-Aug-15 24-Aug-15 03-Sep-15 10-Sep-15 28.00 0% 0% 0.00 Wet area 245.00 19-Oct-14 03-Aug-15 02-Nov-14 20-Aug-15 -5.00 0% 0% 0.00 DHFSH31110 Block Work in Wet Area 6.00 19-Oct-14 26-Oct-14 02-Nov-14 08-Nov-14 46.00 0% 0% 0.00 DHFSH31140 Marking,Cutting & Chasing - Wet Area 4.00 27-Oct-14 30-Oct-14 09-Nov-14 12-Nov-14 46.00 0% 0% 0.00 DHFSH31150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 01-Nov-14 04-Nov-14 13-Nov-14 17-Nov-14 51.00 0% 0% 0.00 DHMEP31170 Plaster in Wet Area 4.00 08-Nov-14 11-Nov-14 20-Nov-14 24-Nov-14 49.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Access from Structure Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Install FAHU's MEP Works in Risers& Clearance Flushing 1st Loop - Upto L30 Ducting ,Cabling,Wiring& Connections Pressure Testing of Pipes Installation of Water Tanks ,Pumps,,Extract Fans,Pressurization Fans Chiller Installation & Wiring,Cable Pulling,Plenum Boxes &fire Sprinklers MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - L31 Construction of Horizontals - L31 Construction of Verticals - L31 Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 42 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 87.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHMEP31180 Wet Area Wall Tiling 6.00 17-Dec-14 24-Dec-14 22-Jan-15 28-Jan-15 1.00 0% 0% 0.00 DHFSH31300 Wet Area False Ceiling Suspension 5.00 29-Dec-14 05-Jan-15 25-Feb-15 03-Mar-15 -15.00 0% 0% 0.00 DHFSH31370 Wet Area False Ceiling Tiling/Boarding 4.00 28-Feb-15 03-Mar-15 15-Mar-15 19-Mar-15 2.00 0% 0% 0.00 DHFSH31210 Wet Area Waterproofing 4.00 04-Mar-15 08-Mar-15 19-Mar-15 24-Mar-15 2.00 0% 0% 0.00 DHFSH31220 Wet Area Floor Screed 4.00 09-Mar-15 12-Mar-15 24-Mar-15 29-Mar-15 2.00 0% 0% 0.00 DHFSH31250 Wet Area Floor Tiling 5.00 14-Mar-15 18-Mar-15 29-Mar-15 04-Apr-15 2.00 0% 0% 0.00 DHFSH06730 Cabinet Carcass 4.00 19-Mar-15 23-Mar-15 07-Apr-15 11-Apr-15 -1.00 0% 0% 0.00 DHFSH31420 Installation of Shower Enclosure 4.00 26-Jul-15 29-Jul-15 11-Aug-15 16-Aug-15 -4.00 0% 0% 0.00 DHFSH31390 Installation of Vanity Counters & Tops 5.00 27-Jul-15 01-Aug-15 12-Aug-15 18-Aug-15 -3.00 0% 0% 0.00 DHFSH31800 Installation of Kitchen Cabinet 12.00 21-Jul-15 03-Aug-15 06-Aug-15 20-Aug-15 -14.00 0% 0% 0.00 Lift Lobby / Corridor 179.00 25-Nov-14 07-Jun-15 09-Dec-14 07-Jul-15 75.00 0% 0% 0.00 DHFSH31240 Corridor/Lift Lobby Floor Screed 4.00 25-Nov-14 29-Nov-14 09-Dec-14 13-Dec-14 46.00 0% 0% 0.00 DHFSH31270 Lift Lobby Painting - Primer & Stucco 6.00 30-Nov-14 07-Dec-14 14-Dec-14 20-Dec-14 46.00 0% 0% 0.00 DHFSH31310 Lift Lobby False Ceiling Suspension 6.00 06-Jan-15 13-Jan-15 04-Mar-15 11-Mar-15 -16.00 0% 0% 0.00 DHFSH31360 Lift Lobby False Ceiling Tiling / Boarding 5.00 28-Feb-15 04-Mar-15 15-Mar-15 21-Mar-15 81.00 0% 0% 0.00 DHFSH31410 Lift Lobby Painting - 1st Coat 6.00 05-Mar-15 11-Mar-15 07-Jun-15 13-Jun-15 15.00 0% 0% 0.00 DHFSH31440 Installation of Steel Doors & Windows 3.00 04-Jun-15 07-Jun-15 18-Jun-15 21-Jun-15 -12.00 0% 0% 0.00 DHFSH31470 Lift Lobby Flooring 6.00 01-Apr-15 07-Apr-15 24-Jun-15 30-Jun-15 75.00 0% 0% 0.00 DHFSH31490 Utility Rooms- Epoxy Flooring 6.00 08-Apr-15 14-Apr-15 01-Jul-15 07-Jul-15 75.00 0% 0% 0.00 Staircase 179.00 17-Nov-14 16-Jun-15 30-Nov-14 29-Jun-15 16.00 0% 0% 0.00 DHFSH31200 Staircase Plastering 4.00 17-Nov-14 20-Nov-14 30-Nov-14 04-Dec-14 148.00 0% 0% 0.00 DHFSH31280 Staircase Painting - Primer & Stucco 6.00 08-Dec-14 14-Dec-14 21-Dec-14 27-Dec-14 135.00 0% 0% 0.00 DHFSH31320 Staircase Handrail Fixing 3.00 03-Mar-15 07-Mar-15 14-Jan-15 17-Jan-15 140.00 0% 0% 0.00 DHFSH31330 Staircase Painting 1st Coat 3.00 17-Mar-15 19-Mar-15 18-Jun-15 21-Jun-15 11.00 0% 0% 0.00 DHFSH31340 Staircase Final Painting 5.00 08-Jun-15 13-Jun-15 22-Jun-15 27-Jun-15 16.00 0% 0% 0.00 DHFSH31380 Staircase Epoxy Flooring 2.00 15-Jun-15 16-Jun-15 28-Jun-15 29-Jun-15 16.00 0% 0% 0.00 General 299.00 22-Sep-14 07-Sep-15 21-Sep-14 A 27-Sep-15 28.00 0% 0% 0.00 DHSTR31000 Access from Structure 0.00 22-Sep-14 21-Sep-14 A 100% 100% 0.00 DHFSH31510 Snagging & De-Snagging 12.00 25-Aug-15 07-Sep-15 10-Sep-15 27-Sep-15 28.00 0% 0% 0.00 MEP - LEVEL 31 534.00 28-Aug-14 17-Aug-15 29-Aug-14 A 22-Dec-15 -63.00 15.54% 6.3% 0.41 DHMEP31000 Embeded Conduits & Boxex - Concrete Works 3.00 28-Aug-14 31-Aug-14 29-Aug-14 A 31-Aug-14 A 100% 100% 0.00 DHMEP31100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C22a-bSlienpg- 1, 4Wiring et1c4-Oct-14 22-Sep-14 A 20-Oct-14 -5.00 44.44% 18% 0.41 DHMEP31130 Cable Trays & Cable Trunking 6.00 27-Oct-14 02-Nov-14 09-Nov-14 15-Nov-14 56.00 0% 0% 0.00 DHMEP31120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 01-Nov-14 06-Nov-14 13-Nov-14 19-Nov-14 46.00 0% 0% 0.00 DHMEP31160 Pressure Testing of Pipes 12.00 08-Nov-14 20-Nov-14 20-Nov-14 04-Dec-14 73.00 0% 0% 0.00 DHMEP31110 MEP Works in Risers& Clearance 5.00 22-Dec-14 27-Dec-14 28-Sep-14 A 04-Feb-15 -33.00 0% 11% 0.00 DHMEP31140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es21-Feb-15 26-Feb-15 08-Mar-15 15-Mar-15 -7.00 0% 0% 0.00 DHMEP31150 MEP Final Fixes 6.00 30-Jul-15 05-Aug-15 16-Aug-15 23-Aug-15 25.00 0% 0% 0.00 DHMEP06430 Sanitary ware /Toilet accessories 6.00 03-Aug-15 09-Aug-15 19-Aug-15 26-Aug-15 28.00 0% 0% 0.00 DHMEP31200 Pre-Testing & Commissioning 7.00 10-Aug-15 17-Aug-15 26-Aug-15 03-Sep-15 28.00 0% 0% 0.00 DHMEP31010 Busbar - L31to L35 12.00 14-Jun-15 27-Jun-15 09-Dec-15 22-Dec-15 -144.00 0% 0% 0.00 LEVEL 32 495.00 19-Aug-14 13-Sep-15 19-Aug-14 A 09-Nov-15 -6.00 38.69% 36.32% 0.94 STRUCTURAL WORKS - LEVEL 32 18.00 19-Aug-14 08-Sep-14 19-Aug-14 A 09-Sep-14 A 100% 100% 1.00 DHCWA33100 Core Wall - L32 4.00 19-Aug-14 23-Aug-14 19-Aug-14 A 24-Aug-14 A 100% 100% 1.00 DHSLA32100 Construction of Horizontals - L32 4.00 02-Sep-14 06-Sep-14 02-Sep-14 A 07-Sep-14 A 100% 100% 1.00 DHCWA33110 Construction of Verticals - L32 2.00 07-Sep-14 08-Sep-14 08-Sep-14 A 09-Sep-14 A 100% 100% 1.00 STAIRCASES 4.00 05-Nov-14 09-Nov-14 10-Nov-14 13-Nov-14 45.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Shower Enclosure Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - L32 Construction of Horizontals - L32 Construction of Verticals - L32 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 43 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 88.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 A1820 Stair # 1 4.00 05-Nov-14 09-Nov-14 10-Nov-14 13-Nov-14 10.00 0% 0% 0.00 A1830 Stair # 2 3.00 06-Nov-14 09-Nov-14 11-Nov-14 13-Nov-14 45.00 0% 0% 0.00 FINISHES WORKS - LEVEL 32 336.00 28-Sep-14 13-Sep-15 01-Oct-14 09-Nov-15 -6.00 0% 0% 0.00 Dry area 296.00 23-Oct-14 30-Aug-15 06-Nov-14 26-Oct-15 -6.00 0% 0% 0.00 DHFSH32100 Block Work in Dry Area 6.00 23-Oct-14 30-Oct-14 06-Nov-14 12-Nov-14 -5.00 0% 0% 0.00 DHFSH32120 Marking,Cutting & Chasing - Dry Area 4.00 01-Nov-14 04-Nov-14 13-Nov-14 17-Nov-14 45.00 0% 0% 0.00 DHFSH32130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 05-Nov-14 09-Nov-14 18-Nov-14 22-Nov-14 47.00 0% 0% 0.00 DHFSH32160 Plaster in Dry Area 8.00 12-Nov-14 20-Nov-14 25-Nov-14 04-Dec-14 45.00 0% 0% 0.00 DHMEP32190 Dry Area Floor Screed 7.00 22-Nov-14 29-Nov-14 06-Dec-14 13-Dec-14 45.00 0% 0% 0.00 DHFSH32230 Dry Area Painting - Primer 4.00 30-Nov-14 04-Dec-14 14-Dec-14 17-Dec-14 105.00 0% 0% 0.00 DHFSH32260 Dry Area Painting - Stucco 6.00 06-Dec-14 11-Dec-14 18-Dec-14 24-Dec-14 105.00 0% 0% 0.00 DHFSH32290 Dry Area False Ceiling Suspension 6.00 27-Dec-14 04-Jan-15 23-Feb-15 02-Mar-15 -23.00 0% 0% 0.00 DHFSH32350 Dry Area False Ceiling Tiling / Boarding 5.00 03-Mar-15 08-Mar-15 18-Mar-15 24-Mar-15 30.00 0% 0% 0.00 DHFSH32400 Dry Area Painting - 1st Coat 5.00 17-Mar-15 22-Mar-15 18-Jun-15 23-Jun-15 -43.00 0% 0% 0.00 DHFSH32450 Dry Area Flooring 5.00 31-Mar-15 05-Apr-15 24-Jun-15 29-Jun-15 -39.00 0% 0% 0.00 DHFSH32430 Installation of Timber Doors & Ironmongery 5.00 27-Jul-15 01-Aug-15 12-Aug-15 18-Aug-15 -14.00 0% 0% 0.00 DHFSH32802 Installation of Wardrobe 12.00 27-Jul-15 09-Aug-15 12-Aug-15 26-Aug-15 -14.00 0% 0% 0.00 DHFSH32500 Paint Final Coat 6.00 24-Aug-15 30-Aug-15 20-Oct-15 26-Oct-15 -6.00 0% 0% 0.00 Wet area 274.00 23-Oct-14 06-Aug-15 06-Nov-14 29-Sep-15 -35.00 0% 0% 0.00 DHFSH32110 Block Work in Wet Area 6.00 23-Oct-14 30-Oct-14 06-Nov-14 12-Nov-14 45.00 0% 0% 0.00 DHFSH32140 Marking,Cutting & Chasing - Wet Area 4.00 01-Nov-14 04-Nov-14 13-Nov-14 17-Nov-14 45.00 0% 0% 0.00 DHFSH32150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 05-Nov-14 09-Nov-14 18-Nov-14 22-Nov-14 51.00 0% 0% 0.00 DHMEP32170 Plaster in Wet Area 4.00 12-Nov-14 16-Nov-14 25-Nov-14 29-Nov-14 49.00 0% 0% 0.00 DHMEP32180 Wet Area Wall Tiling 6.00 22-Dec-14 29-Dec-14 27-Jan-15 02-Feb-15 1.00 0% 0% 0.00 DHFSH32300 Wet Area False Ceiling Suspension 5.00 04-Jan-15 10-Jan-15 02-Mar-15 08-Mar-15 -16.00 0% 0% 0.00 DHFSH32370 Wet Area False Ceiling Tiling/Boarding 4.00 03-Mar-15 07-Mar-15 18-Mar-15 23-Mar-15 3.00 0% 0% 0.00 DHFSH32210 Wet Area Waterproofing 4.00 08-Mar-15 11-Mar-15 23-Mar-15 28-Mar-15 3.00 0% 0% 0.00 DHFSH32220 Wet Area Floor Screed 4.00 12-Mar-15 16-Mar-15 28-Mar-15 01-Apr-15 3.00 0% 0% 0.00 DHFSH32250 Wet Area Floor Tiling 5.00 17-Mar-15 22-Mar-15 01-Apr-15 07-Apr-15 3.00 0% 0% 0.00 DHFSH06740 Cabinet Carcass 4.00 24-Mar-15 28-Mar-15 12-Apr-15 15-Apr-15 -1.00 0% 0% 0.00 DHFSH32390 Installation of Vanity Counters & Tops 5.00 02-Aug-15 06-Aug-15 18-Aug-15 24-Aug-15 -5.00 0% 0% 0.00 DHFSH32800 Installation of Kitchen Cabinet 12.00 25-Jul-15 06-Aug-15 10-Aug-15 24-Aug-15 -14.00 0% 0% 0.00 DHFSH32420 Installation of Shower Enclosure 4.00 01-Aug-15 04-Aug-15 26-Sep-15 29-Sep-15 -38.00 0% 0% 0.00 Lift Lobby / Corridor 180.00 30-Nov-14 10-Jun-15 14-Dec-14 13-Jul-15 72.00 0% 0% 0.00 DHFSH32240 Corridor/Lift Lobby Floor Screed 4.00 30-Nov-14 04-Dec-14 14-Dec-14 17-Dec-14 45.00 0% 0% 0.00 DHFSH32270 Lift Lobby Painting - Primer & Stucco 6.00 06-Dec-14 11-Dec-14 18-Dec-14 24-Dec-14 45.00 0% 0% 0.00 DHFSH32310 Lift Lobby False Ceiling Suspension 6.00 10-Jan-15 17-Jan-15 08-Mar-15 15-Mar-15 -16.00 0% 0% 0.00 DHFSH32360 Lift Lobby False Ceiling Tiling / Boarding 5.00 03-Mar-15 08-Mar-15 18-Mar-15 24-Mar-15 81.00 0% 0% 0.00 DHFSH32410 Lift Lobby Painting - 1st Coat 6.00 09-Mar-15 15-Mar-15 10-Jun-15 16-Jun-15 15.00 0% 0% 0.00 DHFSH32440 Installation of Steel Doors & Windows 3.00 08-Jun-15 10-Jun-15 24-Jun-15 27-Jun-15 -14.00 0% 0% 0.00 DHFSH32470 Lift Lobby Flooring 6.00 06-Apr-15 12-Apr-15 30-Jun-15 06-Jul-15 72.00 0% 0% 0.00 DHFSH32490 Utility Rooms- Epoxy Flooring 6.00 13-Apr-15 19-Apr-15 07-Jul-15 13-Jul-15 72.00 0% 0% 0.00 Staircase 180.00 22-Nov-14 18-Jun-15 06-Dec-14 05-Jul-15 16.00 0% 0% 0.00 DHFSH32200 Staircase Plastering 4.00 22-Nov-14 25-Nov-14 06-Dec-14 09-Dec-14 147.00 0% 0% 0.00 DHFSH32280 Staircase Painting - Primer & Stucco 6.00 13-Dec-14 18-Dec-14 25-Dec-14 31-Dec-14 134.00 0% 0% 0.00 DHFSH32320 Staircase Handrail Fixing 3.00 07-Mar-15 10-Mar-15 18-Jan-15 20-Jan-15 140.00 0% 0% 0.00 DHFSH32330 Staircase Painting 1st Coat 3.00 23-Mar-15 25-Mar-15 24-Jun-15 27-Jun-15 9.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Installation of Shower Enclosure Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 44 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 89.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH32340 Staircase Final Painting 5.00 11-Jun-15 16-Jun-15 28-Jun-15 02-Jul-15 16.00 0% 0% 0.00 DHFSH32380 Staircase Epoxy Flooring 2.00 17-Jun-15 18-Jun-15 04-Jul-15 05-Jul-15 16.00 0% 0% 0.00 General 336.00 28-Sep-14 13-Sep-15 01-Oct-14 09-Nov-15 -6.00 0% 0% 0.00 DHSTR32000 Access from Structure 0.00 28-Sep-14 01-Oct-14 -3.00 100% 0% 0.00 DHFSH32510 Snagging & De-Snagging 12.00 31-Aug-15 13-Sep-15 27-Oct-15 09-Nov-15 -6.00 0% 0% 0.00 MEP - LEVEL 32 477.00 03-Sep-14 23-Aug-15 02-Sep-14 A 19-Oct-15 -6.00 5.83% 0% 0.00 DHMEP32000 Embeded Conduits & Boxex - Concrete Works 3.00 03-Sep-14 06-Sep-14 02-Sep-14 A 07-Sep-14 A 100% 100% 0.00 DHMEP32100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C28a-bSlienpg- 1, 4Wiring et2c0-Oct-14 06-Oct-14 27-Oct-14 -5.00 16.67% 0% 0.00 DHMEP32130 Cable Trays & Cable Trunking 6.00 01-Nov-14 06-Nov-14 13-Nov-14 19-Nov-14 56.00 0% 0% 0.00 DHMEP32120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 05-Nov-14 11-Nov-14 18-Nov-14 24-Nov-14 45.00 0% 0% 0.00 DHMEP32160 Pressure Testing of Pipes 12.00 12-Nov-14 25-Nov-14 25-Nov-14 09-Dec-14 72.00 0% 0% 0.00 DHMEP32110 MEP Works in Risers& Clearance 5.00 28-Dec-14 03-Jan-15 05-Feb-15 10-Feb-15 -33.00 0% 0% 0.00 DHMEP32140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es24-Feb-15 02-Mar-15 11-Mar-15 18-Mar-15 -7.00 0% 0% 0.00 DHMEP32150 MEP Final Fixes 6.00 05-Aug-15 11-Aug-15 30-Sep-15 06-Oct-15 -9.00 0% 0% 0.00 DHMEP06440 Sanitary ware /Toilet accessories 6.00 09-Aug-15 15-Aug-15 04-Oct-15 10-Oct-15 -6.00 0% 0% 0.00 DHMEP32200 Pre-Testing & Commissioning 7.00 16-Aug-15 23-Aug-15 11-Oct-15 19-Oct-15 -6.00 0% 0% 0.00 LEVEL 33 495.00 24-Aug-14 19-Sep-15 24-Aug-14 A 12-Nov-15 -6.00 36.35% 36.35% 1.00 STRUCTURAL WORKS - LEVEL 33 19.00 24-Aug-14 14-Sep-14 24-Aug-14 A 14-Sep-14 A 100% 100% 1.00 DHCWA34100 Core Wall - L33 5.00 24-Aug-14 28-Aug-14 24-Aug-14 A 28-Aug-14 A 100% 100% 1.00 DHSLA33100 Construction of Horizontals - L33 4.00 08-Sep-14 11-Sep-14 10-Sep-14 A 12-Sep-14 A 100% 100% 1.00 DHCWA34110 Construction of Verticals - L33 2.00 13-Sep-14 14-Sep-14 13-Sep-14 A 14-Sep-14 A 100% 100% 1.00 STAIRCASES 4.00 10-Nov-14 13-Nov-14 15-Nov-14 18-Nov-14 44.00 0% 0% 0.00 A1840 Stair # 1 4.00 10-Nov-14 13-Nov-14 15-Nov-14 18-Nov-14 10.00 0% 0% 0.00 A1850 Stair # 2 3.00 11-Nov-14 13-Nov-14 16-Nov-14 18-Nov-14 44.00 0% 0% 0.00 FINISHES WORKS - LEVEL 33 334.00 06-Oct-14 19-Sep-15 09-Oct-14 12-Nov-15 -6.00 0% 0% 0.00 Dry area 295.00 29-Oct-14 05-Sep-15 11-Nov-14 29-Oct-15 -6.00 0% 0% 0.00 DHFSH33100 Block Work in Dry Area 6.00 29-Oct-14 04-Nov-14 11-Nov-14 17-Nov-14 -5.00 0% 0% 0.00 DHFSH33120 Marking,Cutting & Chasing - Dry Area 4.00 05-Nov-14 09-Nov-14 18-Nov-14 22-Nov-14 44.00 0% 0% 0.00 DHFSH33130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 10-Nov-14 13-Nov-14 23-Nov-14 26-Nov-14 46.00 0% 0% 0.00 DHFSH33160 Plaster in Dry Area 8.00 17-Nov-14 25-Nov-14 30-Nov-14 09-Dec-14 44.00 0% 0% 0.00 DHMEP33190 Dry Area Floor Screed 7.00 26-Nov-14 04-Dec-14 10-Dec-14 17-Dec-14 44.00 0% 0% 0.00 DHFSH33230 Dry Area Painting - Primer 4.00 06-Dec-14 09-Dec-14 18-Dec-14 22-Dec-14 109.00 0% 0% 0.00 DHFSH33260 Dry Area Painting - Stucco 6.00 10-Dec-14 16-Dec-14 23-Dec-14 29-Dec-14 109.00 0% 0% 0.00 DHFSH33290 Dry Area False Ceiling Suspension 6.00 31-Dec-14 08-Jan-15 28-Feb-15 07-Mar-15 -23.00 0% 0% 0.00 DHFSH33350 Dry Area False Ceiling Tiling / Boarding 5.00 21-Mar-15 25-Mar-15 22-Jun-15 27-Jun-15 -43.00 0% 0% 0.00 DHFSH33400 Dry Area Painting - 1st Coat 5.00 26-Mar-15 31-Mar-15 28-Jun-15 02-Jul-15 -43.00 0% 0% 0.00 DHFSH33450 Dry Area Flooring 5.00 05-Apr-15 09-Apr-15 04-Jul-15 08-Jul-15 -43.00 0% 0% 0.00 DHFSH33430 Installation of Timber Doors & Ironmongery 5.00 02-Aug-15 06-Aug-15 18-Aug-15 24-Aug-15 -14.00 0% 0% 0.00 DHFSH33802 Installation of Wardrobe 12.00 01-Aug-15 13-Aug-15 17-Aug-15 31-Aug-15 -14.00 0% 0% 0.00 DHFSH33500 Paint Final Coat 6.00 30-Aug-15 05-Sep-15 24-Oct-15 29-Oct-15 -6.00 0% 0% 0.00 Wet area 273.00 29-Oct-14 12-Aug-15 11-Nov-14 03-Oct-15 -35.00 0% 0% 0.00 DHFSH33110 Block Work in Wet Area 6.00 29-Oct-14 04-Nov-14 11-Nov-14 17-Nov-14 44.00 0% 0% 0.00 DHFSH33140 Marking,Cutting & Chasing - Wet Area 4.00 05-Nov-14 09-Nov-14 18-Nov-14 22-Nov-14 44.00 0% 0% 0.00 DHFSH33150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 10-Nov-14 13-Nov-14 23-Nov-14 26-Nov-14 51.00 0% 0% 0.00 DHMEP33170 Plaster in Wet Area 4.00 17-Nov-14 20-Nov-14 30-Nov-14 04-Dec-14 49.00 0% 0% 0.00 DHMEP33180 Wet Area Wall Tiling 6.00 27-Dec-14 04-Jan-15 01-Feb-15 07-Feb-15 1.00 0% 0% 0.00 DHFSH33300 Wet Area False Ceiling Suspension 5.00 08-Jan-15 14-Jan-15 07-Mar-15 12-Mar-15 -17.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - L33 Construction of Horizontals - L33 Construction of Verticals - L33 Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 45 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 90.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH33370 Wet Area False Ceiling Tiling/Boarding 4.00 07-Mar-15 10-Mar-15 23-Mar-15 28-Mar-15 3.00 0% 0% 0.00 DHFSH33210 Wet Area Waterproofing 4.00 11-Mar-15 15-Mar-15 28-Mar-15 01-Apr-15 3.00 0% 0% 0.00 DHFSH33220 Wet Area Floor Screed 4.00 16-Mar-15 19-Mar-15 01-Apr-15 06-Apr-15 3.00 0% 0% 0.00 DHFSH33250 Wet Area Floor Tiling 5.00 21-Mar-15 25-Mar-15 06-Apr-15 12-Apr-15 3.00 0% 0% 0.00 DHFSH06750 Cabinet Carcass 4.00 29-Mar-15 01-Apr-15 16-Apr-15 20-Apr-15 -1.00 0% 0% 0.00 DHFSH33800 Installation of Kitchen Cabinet 12.00 28-Jul-15 10-Aug-15 13-Aug-15 27-Aug-15 -14.00 0% 0% 0.00 DHFSH33390 Installation of Vanity Counters & Tops 5.00 08-Aug-15 12-Aug-15 24-Aug-15 30-Aug-15 -7.00 0% 0% 0.00 DHFSH33420 Installation of Shower Enclosure 4.00 06-Aug-15 10-Aug-15 29-Sep-15 03-Oct-15 -38.00 0% 0% 0.00 Lift Lobby / Corridor 184.00 06-Dec-14 14-Jun-15 18-Dec-14 25-Jul-15 66.00 0% 0% 0.00 DHFSH33240 Corridor/Lift Lobby Floor Screed 4.00 06-Dec-14 09-Dec-14 18-Dec-14 22-Dec-14 44.00 0% 0% 0.00 DHFSH33270 Lift Lobby Painting - Primer & Stucco 6.00 10-Dec-14 16-Dec-14 23-Dec-14 29-Dec-14 44.00 0% 0% 0.00 DHFSH33310 Lift Lobby False Ceiling Suspension 6.00 14-Jan-15 21-Jan-15 12-Mar-15 19-Mar-15 -17.00 0% 0% 0.00 DHFSH33360 Lift Lobby False Ceiling Tiling / Boarding 5.00 07-Mar-15 11-Mar-15 23-Mar-15 29-Mar-15 80.00 0% 0% 0.00 DHFSH33410 Lift Lobby Painting - 1st Coat 6.00 12-Mar-15 18-Mar-15 14-Jun-15 20-Jun-15 15.00 0% 0% 0.00 DHFSH33440 Installation of Steel Doors & Windows 3.00 11-Jun-15 14-Jun-15 04-Jul-15 06-Jul-15 -19.00 0% 0% 0.00 DHFSH33470 Lift Lobby Flooring 6.00 11-Apr-15 16-Apr-15 09-Jul-15 15-Jul-15 66.00 0% 0% 0.00 DHFSH33490 Utility Rooms- Epoxy Flooring 6.00 18-Apr-15 23-Apr-15 16-Jul-15 25-Jul-15 66.00 0% 0% 0.00 Staircase 184.00 26-Nov-14 22-Jun-15 10-Dec-14 14-Jul-15 13.00 0% 0% 0.00 DHFSH33200 Staircase Plastering 4.00 26-Nov-14 30-Nov-14 10-Dec-14 14-Dec-14 146.00 0% 0% 0.00 DHFSH33280 Staircase Painting - Primer & Stucco 6.00 17-Dec-14 23-Dec-14 30-Dec-14 06-Jan-15 133.00 0% 0% 0.00 DHFSH33320 Staircase Handrail Fixing 3.00 10-Mar-15 14-Mar-15 21-Jan-15 24-Jan-15 140.00 0% 0% 0.00 DHFSH33330 Staircase Painting 1st Coat 3.00 01-Apr-15 04-Apr-15 04-Jul-15 06-Jul-15 4.00 0% 0% 0.00 DHFSH33340 Staircase Final Painting 5.00 15-Jun-15 20-Jun-15 07-Jul-15 12-Jul-15 13.00 0% 0% 0.00 DHFSH33380 Staircase Epoxy Flooring 2.00 21-Jun-15 22-Jun-15 13-Jul-15 14-Jul-15 13.00 0% 0% 0.00 General 334.00 06-Oct-14 19-Sep-15 09-Oct-14 12-Nov-15 -6.00 0% 0% 0.00 DHSTR33000 Access from Structure 0.00 06-Oct-14 09-Oct-14 -2.00 0% 0% 0.00 DHFSH33510 Snagging & De-Snagging 12.00 06-Sep-15 19-Sep-15 31-Oct-15 12-Nov-15 -6.00 0% 0% 0.00 MEP - LEVEL 33 477.00 09-Sep-14 29-Aug-15 10-Sep-14 A 22-Oct-15 -6.00 0% 0% 0.00 DHMEP33000 Embeded Conduits & Boxex - Concrete Works 3.00 09-Sep-14 11-Sep-14 10-Sep-14 A 12-Sep-14 A 100% 100% 0.00 DHMEP33100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C07a-bOlicntg-1 ,4 Wiring et2c8-Oct-14 13-Oct-14 03-Nov-14 -5.00 0% 0% 0.00 DHMEP33130 Cable Trays & Cable Trunking 6.00 05-Nov-14 11-Nov-14 18-Nov-14 24-Nov-14 56.00 0% 0% 0.00 DHMEP33120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 10-Nov-14 16-Nov-14 23-Nov-14 29-Nov-14 44.00 0% 0% 0.00 DHMEP33160 Pressure Testing of Pipes 12.00 17-Nov-14 30-Nov-14 30-Nov-14 14-Dec-14 71.00 0% 0% 0.00 DHMEP33110 MEP Works in Risers& Clearance 5.00 04-Jan-15 08-Jan-15 11-Feb-15 16-Feb-15 -33.00 0% 0% 0.00 DHMEP33140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es28-Feb-15 05-Mar-15 16-Mar-15 23-Mar-15 -8.00 0% 0% 0.00 DHMEP33150 MEP Final Fixes 6.00 11-Aug-15 17-Aug-15 04-Oct-15 10-Oct-15 -9.00 0% 0% 0.00 DHMEP06450 Sanitary ware /Toilet accessories 6.00 15-Aug-15 20-Aug-15 07-Oct-15 14-Oct-15 -6.00 0% 0% 0.00 DHMEP33200 Pre-Testing & Commissioning 7.00 22-Aug-15 29-Aug-15 15-Oct-15 22-Oct-15 -6.00 0% 0% 0.00 LEVEL 34 495.00 30-Aug-14 22-Sep-15 30-Aug-14 A 16-Nov-15 -6.00 36.39% 36.39% 1.00 STRUCTURAL WORKS - LEVEL 34 25.00 30-Aug-14 18-Sep-14 30-Aug-14 A 21-Sep-14 A 100% 100% 1.00 DHCWA35100 Core Wall - L34 5.00 30-Aug-14 03-Sep-14 30-Aug-14 A 03-Sep-14 A 100% 100% 1.00 DHCWA35120 Tower Crane Jump 1.00 30-Aug-14 30-Aug-14 06-Sep-14 A 07-Sep-14 A 100% 100% 0.00 DHSLA34100 Construction of Horizontals - L34 4.00 13-Sep-14 16-Sep-14 15-Sep-14 A 18-Sep-14 A 100% 100% 1.00 DHCWA35110 Construction of Verticals - L34 2.00 17-Sep-14 18-Sep-14 20-Sep-14 A 21-Sep-14 A 100% 100% 1.00 STAIRCASES 4.00 16-Nov-14 19-Nov-14 20-Nov-14 24-Nov-14 42.00 0% 0% 0.00 A1860 Stair # 1 4.00 16-Nov-14 19-Nov-14 20-Nov-14 24-Nov-14 9.00 0% 0% 0.00 A1870 Stair # 2 3.00 17-Nov-14 19-Nov-14 22-Nov-14 24-Nov-14 42.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Kitchen Cabinet Installation of Vanity Counters & Tops Installation of Shower Enclosure Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - L34 Tower Crane Jump Construction of Horizontals - L34 Construction of Verticals - L34 Stair # 1 Stair # 2 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 46 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 91.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 FINISHES WORKS - LEVEL 34 334.00 09-Oct-14 22-Sep-15 13-Oct-14 16-Nov-15 -6.00 0% 0% 0.00 Dry area 293.00 05-Nov-14 08-Sep-15 17-Nov-14 02-Nov-15 -6.00 0% 0% 0.00 DHFSH34100 Block Work in Dry Area 6.00 05-Nov-14 11-Nov-14 17-Nov-14 23-Nov-14 -5.00 0% 0% 0.00 DHFSH34120 Marking,Cutting & Chasing - Dry Area 4.00 12-Nov-14 16-Nov-14 24-Nov-14 27-Nov-14 42.00 0% 0% 0.00 DHFSH34130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 17-Nov-14 20-Nov-14 29-Nov-14 03-Dec-14 44.00 0% 0% 0.00 DHFSH34160 Plaster in Dry Area 8.00 24-Nov-14 03-Dec-14 07-Dec-14 15-Dec-14 42.00 0% 0% 0.00 DHMEP34190 Dry Area Floor Screed 7.00 04-Dec-14 11-Dec-14 16-Dec-14 23-Dec-14 42.00 0% 0% 0.00 DHFSH34230 Dry Area Painting - Primer 4.00 13-Dec-14 16-Dec-14 24-Dec-14 28-Dec-14 108.00 0% 0% 0.00 DHFSH34260 Dry Area Painting - Stucco 6.00 17-Dec-14 23-Dec-14 29-Dec-14 05-Jan-15 108.00 0% 0% 0.00 DHFSH34290 Dry Area False Ceiling Suspension 6.00 06-Jan-15 13-Jan-15 04-Mar-15 11-Mar-15 -23.00 0% 0% 0.00 DHFSH34350 Dry Area False Ceiling Tiling / Boarding 5.00 10-Mar-15 15-Mar-15 28-Mar-15 02-Apr-15 34.00 0% 0% 0.00 DHFSH34400 Dry Area Painting - 1st Coat 5.00 26-Mar-15 31-Mar-15 28-Jun-15 02-Jul-15 -39.00 0% 0% 0.00 DHFSH34450 Dry Area Flooring 5.00 09-Apr-15 14-Apr-15 08-Jul-15 13-Jul-15 -43.00 0% 0% 0.00 DHFSH34430 Installation of Timber Doors & Ironmongery 5.00 05-Aug-15 10-Aug-15 22-Aug-15 27-Aug-15 -14.00 0% 0% 0.00 DHFSH34802 Installation of Wardrobe 12.00 05-Aug-15 18-Aug-15 22-Aug-15 05-Sep-15 -14.00 0% 0% 0.00 DHFSH34500 Paint Final Coat 6.00 02-Sep-15 08-Sep-15 27-Oct-15 02-Nov-15 -6.00 0% 0% 0.00 Wet area 271.00 05-Nov-14 16-Aug-15 17-Nov-14 06-Oct-15 -35.00 0% 0% 0.00 DHFSH34110 Block Work in Wet Area 6.00 05-Nov-14 11-Nov-14 17-Nov-14 23-Nov-14 42.00 0% 0% 0.00 DHFSH34140 Marking,Cutting & Chasing - Wet Area 4.00 12-Nov-14 16-Nov-14 24-Nov-14 27-Nov-14 42.00 0% 0% 0.00 DHFSH34150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 17-Nov-14 20-Nov-14 29-Nov-14 03-Dec-14 50.00 0% 0% 0.00 DHMEP34170 Plaster in Wet Area 4.00 24-Nov-14 27-Nov-14 07-Dec-14 10-Dec-14 48.00 0% 0% 0.00 DHMEP34180 Wet Area Wall Tiling 6.00 31-Dec-14 08-Jan-15 05-Feb-15 11-Feb-15 1.00 0% 0% 0.00 DHFSH34300 Wet Area False Ceiling Suspension 5.00 13-Jan-15 19-Jan-15 11-Mar-15 17-Mar-15 -18.00 0% 0% 0.00 DHFSH34370 Wet Area False Ceiling Tiling/Boarding 4.00 10-Mar-15 14-Mar-15 28-Mar-15 01-Apr-15 3.00 0% 0% 0.00 DHFSH34210 Wet Area Waterproofing 4.00 15-Mar-15 18-Mar-15 01-Apr-15 06-Apr-15 3.00 0% 0% 0.00 DHFSH34220 Wet Area Floor Screed 4.00 19-Mar-15 23-Mar-15 06-Apr-15 11-Apr-15 3.00 0% 0% 0.00 DHFSH34250 Wet Area Floor Tiling 5.00 24-Mar-15 29-Mar-15 11-Apr-15 16-Apr-15 3.00 0% 0% 0.00 DHFSH06760 Cabinet Carcass 4.00 02-Apr-15 06-Apr-15 21-Apr-15 25-Apr-15 -1.00 0% 0% 0.00 DHFSH34800 Installation of Kitchen Cabinet 12.00 01-Aug-15 13-Aug-15 17-Aug-15 31-Aug-15 -14.00 0% 0% 0.00 DHFSH34390 Installation of Vanity Counters & Tops 5.00 11-Aug-15 16-Aug-15 27-Aug-15 02-Sep-15 -7.00 0% 0% 0.00 DHFSH34420 Installation of Shower Enclosure 4.00 10-Aug-15 13-Aug-15 03-Oct-15 06-Oct-15 -38.00 0% 0% 0.00 Lift Lobby / Corridor 183.00 13-Dec-14 17-Jun-15 24-Dec-14 29-Jul-15 64.00 0% 0% 0.00 DHFSH34240 Corridor/Lift Lobby Floor Screed 4.00 13-Dec-14 16-Dec-14 24-Dec-14 28-Dec-14 42.00 0% 0% 0.00 DHFSH34270 Lift Lobby Painting - Primer & Stucco 6.00 17-Dec-14 23-Dec-14 29-Dec-14 05-Jan-15 42.00 0% 0% 0.00 DHFSH34310 Lift Lobby False Ceiling Suspension 6.00 19-Jan-15 26-Jan-15 17-Mar-15 24-Mar-15 -18.00 0% 0% 0.00 DHFSH34360 Lift Lobby False Ceiling Tiling / Boarding 5.00 10-Mar-15 15-Mar-15 28-Mar-15 02-Apr-15 79.00 0% 0% 0.00 DHFSH34410 Lift Lobby Painting - 1st Coat 6.00 16-Mar-15 22-Mar-15 17-Jun-15 23-Jun-15 15.00 0% 0% 0.00 DHFSH34440 Installation of Steel Doors & Windows 3.00 15-Jun-15 17-Jun-15 07-Jul-15 09-Jul-15 -19.00 0% 0% 0.00 DHFSH34470 Lift Lobby Flooring 6.00 15-Apr-15 21-Apr-15 14-Jul-15 22-Jul-15 64.00 0% 0% 0.00 DHFSH34490 Utility Rooms- Epoxy Flooring 6.00 22-Apr-15 28-Apr-15 23-Jul-15 29-Jul-15 64.00 0% 0% 0.00 Staircase 182.00 04-Dec-14 25-Jun-15 16-Dec-14 20-Jul-15 13.00 0% 0% 0.00 DHFSH34200 Staircase Plastering 4.00 04-Dec-14 08-Dec-14 16-Dec-14 20-Dec-14 144.00 0% 0% 0.00 DHFSH34280 Staircase Painting - Primer & Stucco 6.00 24-Dec-14 30-Dec-14 06-Jan-15 12-Jan-15 131.00 0% 0% 0.00 DHFSH34320 Staircase Handrail Fixing 3.00 14-Mar-15 17-Mar-15 25-Jan-15 27-Jan-15 140.00 0% 0% 0.00 DHFSH34330 Staircase Painting 1st Coat 3.00 05-Apr-15 07-Apr-15 07-Jul-15 09-Jul-15 4.00 0% 0% 0.00 DHFSH34340 Staircase Final Painting 5.00 18-Jun-15 23-Jun-15 11-Jul-15 15-Jul-15 13.00 0% 0% 0.00 DHFSH34380 Staircase Epoxy Flooring 2.00 24-Jun-15 25-Jun-15 16-Jul-15 20-Jul-15 13.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Kitchen Cabinet Installation of Vanity Counters & Tops Installation of Shower Enclosure Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 47 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 92.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 General 334.00 09-Oct-14 22-Sep-15 13-Oct-14 16-Nov-15 -6.00 0% 0% 0.00 DHSTR34000 Access from Structure 0.00 09-Oct-14 13-Oct-14 1.00 0% 0% 0.00 DHFSH34510 Snagging & De-Snagging 12.00 09-Sep-15 22-Sep-15 03-Nov-15 16-Nov-15 -6.00 0% 0% 0.00 MEP - LEVEL 34 477.00 14-Sep-14 01-Sep-15 15-Sep-14 A 26-Oct-15 -6.00 0% 0% 0.00 DHMEP34000 Embeded Conduits & Boxex - Concrete Works 3.00 14-Sep-14 16-Sep-14 15-Sep-14 A 18-Sep-14 A 100% 100% 0.00 DHMEP34100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C14a-bOlicntg-1 ,4 Wiring et0c4-Nov-14 20-Oct-14 10-Nov-14 -5.00 0% 0% 0.00 DHMEP34130 Cable Trays & Cable Trunking 6.00 12-Nov-14 18-Nov-14 24-Nov-14 30-Nov-14 55.00 0% 0% 0.00 DHMEP34120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 17-Nov-14 23-Nov-14 29-Nov-14 06-Dec-14 42.00 0% 0% 0.00 DHMEP34160 Pressure Testing of Pipes 12.00 24-Nov-14 08-Dec-14 07-Dec-14 20-Dec-14 69.00 0% 0% 0.00 DHMEP34110 MEP Works in Risers& Clearance 5.00 10-Jan-15 14-Jan-15 17-Feb-15 22-Feb-15 -33.00 0% 0% 0.00 DHMEP34140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es03-Mar-15 09-Mar-15 21-Mar-15 28-Mar-15 -9.00 0% 0% 0.00 DHMEP34150 MEP Final Fixes 6.00 15-Aug-15 20-Aug-15 07-Oct-15 14-Oct-15 -9.00 0% 0% 0.00 DHMEP06460 Sanitary ware /Toilet accessories 6.00 18-Aug-15 24-Aug-15 11-Oct-15 18-Oct-15 -6.00 0% 0% 0.00 DHMEP34200 Pre-Testing & Commissioning 7.00 25-Aug-15 01-Sep-15 19-Oct-15 26-Oct-15 -6.00 0% 0% 0.00 LEVEL 35 368.00 04-Sep-14 28-Sep-15 04-Sep-14 A 19-Nov-15 -6.00 36.42% 36.42% 1.00 STRUCTURAL WORKS - LEVEL 35 21.00 04-Sep-14 23-Sep-14 04-Sep-14 A 27-Sep-14 A 100% 100% 1.00 DHCWA36100 Core Wall - L35 4.00 04-Sep-14 08-Sep-14 04-Sep-14 A 14-Sep-14 A 100% 100% 1.00 DHSLA35100 Construction of Horizontals - L35 4.00 17-Sep-14 21-Sep-14 22-Sep-14 A 24-Sep-14 A 100% 100% 1.00 DHCWA36110 Construction of Verticals - L35 2.00 22-Sep-14 23-Sep-14 25-Sep-14 A 27-Sep-14 A 100% 100% 1.00 STAIRCASES 4.00 22-Nov-14 25-Nov-14 26-Nov-14 30-Nov-14 41.00 0% 0% 0.00 A1880 Stair # 1 4.00 22-Nov-14 25-Nov-14 26-Nov-14 30-Nov-14 8.00 0% 0% 0.00 A1890 Stair # 2 4.00 22-Nov-14 25-Nov-14 26-Nov-14 30-Nov-14 41.00 0% 0% 0.00 FINISHES WORKS - LEVEL 35 333.00 14-Oct-14 28-Sep-15 18-Oct-14 19-Nov-15 -6.00 0% 0% 0.00 Dry area 292.00 12-Nov-14 12-Sep-15 22-Nov-14 05-Nov-15 -6.00 0% 0% 0.00 DHFSH35100 Block Work in Dry Area 6.00 12-Nov-14 18-Nov-14 22-Nov-14 27-Nov-14 -5.00 0% 0% 0.00 DHFSH35120 Marking,Cutting & Chasing - Dry Area 4.00 19-Nov-14 23-Nov-14 29-Nov-14 03-Dec-14 41.00 0% 0% 0.00 DHFSH35130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 24-Nov-14 27-Nov-14 04-Dec-14 08-Dec-14 43.00 0% 0% 0.00 DHFSH35160 Plaster in Dry Area 8.00 01-Dec-14 10-Dec-14 11-Dec-14 20-Dec-14 41.00 0% 0% 0.00 DHMEP35190 Dry Area Floor Screed 7.00 11-Dec-14 18-Dec-14 21-Dec-14 28-Dec-14 41.00 0% 0% 0.00 DHFSH35230 Dry Area Painting - Primer 4.00 20-Dec-14 23-Dec-14 29-Dec-14 03-Jan-15 108.00 0% 0% 0.00 DHFSH35260 Dry Area Painting - Stucco 6.00 24-Dec-14 30-Dec-14 04-Jan-15 10-Jan-15 108.00 0% 0% 0.00 DHFSH35290 Dry Area False Ceiling Suspension 6.00 11-Jan-15 18-Jan-15 09-Mar-15 16-Mar-15 -23.00 0% 0% 0.00 DHFSH35350 Dry Area False Ceiling Tiling / Boarding 5.00 14-Mar-15 18-Mar-15 01-Apr-15 07-Apr-15 34.00 0% 0% 0.00 DHFSH35400 Dry Area Painting - 1st Coat 5.00 30-Mar-15 04-Apr-15 01-Jul-15 06-Jul-15 -38.00 0% 0% 0.00 DHFSH35450 Dry Area Flooring 5.00 14-Apr-15 19-Apr-15 13-Jul-15 20-Jul-15 -43.00 0% 0% 0.00 DHFSH35430 Installation of Timber Doors & Ironmongery 5.00 09-Aug-15 13-Aug-15 25-Aug-15 31-Aug-15 -14.00 0% 0% 0.00 DHFSH35802 Installation of Wardrobe 12.00 10-Aug-15 23-Aug-15 26-Aug-15 09-Sep-15 -14.00 0% 0% 0.00 DHFSH35500 Paint Final Coat 6.00 06-Sep-15 12-Sep-15 31-Oct-15 05-Nov-15 -6.00 0% 0% 0.00 Wet area 270.00 12-Nov-14 19-Aug-15 22-Nov-14 10-Oct-15 -35.00 0% 0% 0.00 DHFSH35110 Block Work in Wet Area 6.00 12-Nov-14 18-Nov-14 22-Nov-14 27-Nov-14 41.00 0% 0% 0.00 DHFSH35140 Marking,Cutting & Chasing - Wet Area 4.00 19-Nov-14 23-Nov-14 29-Nov-14 03-Dec-14 41.00 0% 0% 0.00 DHFSH35150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 24-Nov-14 27-Nov-14 04-Dec-14 08-Dec-14 50.00 0% 0% 0.00 DHMEP35170 Plaster in Wet Area 4.00 01-Dec-14 06-Dec-14 11-Dec-14 15-Dec-14 48.00 0% 0% 0.00 DHMEP35180 Wet Area Wall Tiling 6.00 06-Jan-15 13-Jan-15 10-Feb-15 16-Feb-15 1.00 0% 0% 0.00 DHFSH35300 Wet Area False Ceiling Suspension 5.00 18-Jan-15 24-Jan-15 16-Mar-15 22-Mar-15 -19.00 0% 0% 0.00 DHFSH35370 Wet Area False Ceiling Tiling/Boarding 4.00 14-Mar-15 17-Mar-15 01-Apr-15 06-Apr-15 3.00 0% 0% 0.00 DHFSH35210 Wet Area Waterproofing 4.00 18-Mar-15 22-Mar-15 06-Apr-15 11-Apr-15 3.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - L35 Construction of Horizontals - L35 Construction of Verticals - L35 Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 48 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 93.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH35220 Wet Area Floor Screed 4.00 23-Mar-15 26-Mar-15 11-Apr-15 15-Apr-15 3.00 0% 0% 0.00 DHFSH35250 Wet Area Floor Tiling 5.00 28-Mar-15 01-Apr-15 15-Apr-15 21-Apr-15 3.00 0% 0% 0.00 DHFSH06770 Cabinet Carcass 4.00 07-Apr-15 11-Apr-15 26-Apr-15 29-Apr-15 -1.00 0% 0% 0.00 DHFSH35800 Installation of Kitchen Cabinet 12.00 04-Aug-15 17-Aug-15 20-Aug-15 03-Sep-15 -14.00 0% 0% 0.00 DHFSH35390 Installation of Vanity Counters & Tops 5.00 15-Aug-15 19-Aug-15 31-Aug-15 06-Sep-15 -7.00 0% 0% 0.00 DHFSH35420 Installation of Shower Enclosure 4.00 13-Aug-15 17-Aug-15 06-Oct-15 10-Oct-15 -38.00 0% 0% 0.00 Lift Lobby / Corridor 183.00 20-Dec-14 21-Jun-15 29-Dec-14 03-Aug-15 62.00 0% 0% 0.00 DHFSH35240 Corridor/Lift Lobby Floor Screed 4.00 20-Dec-14 23-Dec-14 29-Dec-14 03-Jan-15 41.00 0% 0% 0.00 DHFSH35270 Lift Lobby Painting - Primer & Stucco 6.00 24-Dec-14 30-Dec-14 04-Jan-15 10-Jan-15 41.00 0% 0% 0.00 DHFSH35310 Lift Lobby False Ceiling Suspension 6.00 24-Jan-15 31-Jan-15 22-Mar-15 29-Mar-15 -19.00 0% 0% 0.00 DHFSH35360 Lift Lobby False Ceiling Tiling / Boarding 5.00 14-Mar-15 18-Mar-15 01-Apr-15 07-Apr-15 78.00 0% 0% 0.00 DHFSH35410 Lift Lobby Painting - 1st Coat 6.00 19-Mar-15 25-Mar-15 21-Jun-15 27-Jun-15 15.00 0% 0% 0.00 DHFSH35440 Installation of Steel Doors & Windows 3.00 18-Jun-15 21-Jun-15 11-Jul-15 13-Jul-15 -19.00 0% 0% 0.00 DHFSH35470 Lift Lobby Flooring 6.00 20-Apr-15 26-Apr-15 21-Jul-15 27-Jul-15 62.00 0% 0% 0.00 DHFSH35490 Utility Rooms- Epoxy Flooring 6.00 27-Apr-15 03-May-15 28-Jul-15 03-Aug-15 62.00 0% 0% 0.00 Staircase 181.00 11-Dec-14 29-Jun-15 21-Dec-14 23-Jul-15 13.00 0% 0% 0.00 DHFSH35200 Staircase Plastering 4.00 11-Dec-14 15-Dec-14 21-Dec-14 24-Dec-14 143.00 0% 0% 0.00 DHFSH35280 Staircase Painting - Primer & Stucco 6.00 31-Dec-14 07-Jan-15 11-Jan-15 17-Jan-15 130.00 0% 0% 0.00 DHFSH35320 Staircase Handrail Fixing 3.00 17-Mar-15 21-Mar-15 28-Jan-15 31-Jan-15 140.00 0% 0% 0.00 DHFSH35330 Staircase Painting 1st Coat 3.00 08-Apr-15 11-Apr-15 11-Jul-15 13-Jul-15 4.00 0% 0% 0.00 DHFSH35340 Staircase Final Painting 5.00 22-Jun-15 27-Jun-15 14-Jul-15 21-Jul-15 13.00 0% 0% 0.00 DHFSH35380 Staircase Epoxy Flooring 2.00 28-Jun-15 29-Jun-15 22-Jul-15 23-Jul-15 13.00 0% 0% 0.00 General 333.00 14-Oct-14 28-Sep-15 18-Oct-14 19-Nov-15 -6.00 0% 0% 0.00 DHSTR35000 Access from Structure 0.00 14-Oct-14 18-Oct-14 3.00 0% 0% 0.00 DHFSH35510 Snagging & De-Snagging 12.00 13-Sep-15 28-Sep-15 07-Nov-15 19-Nov-15 -6.00 0% 0% 0.00 MEP - LEVEL 35 333.00 18-Sep-14 05-Sep-15 23-Sep-14 A 29-Oct-15 -6.00 0% 0% 0.00 DHMEP35000 Embeded Conduits & Boxex - Concrete Works 3.00 18-Sep-14 21-Sep-14 23-Sep-14 A 24-Sep-14 A 100% 100% 0.00 DHMEP35100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C21a-bOlicntg-1 ,4 Wiring et1c1-Nov-14 28-Oct-14 17-Nov-14 -5.00 0% 0% 0.00 DHMEP35130 Cable Trays & Cable Trunking 6.00 19-Nov-14 25-Nov-14 29-Nov-14 06-Dec-14 55.00 0% 0% 0.00 DHMEP35120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 24-Nov-14 30-Nov-14 04-Dec-14 10-Dec-14 41.00 0% 0% 0.00 DHMEP35160 Pressure Testing of Pipes 12.00 01-Dec-14 15-Dec-14 11-Dec-14 24-Dec-14 68.00 0% 0% 0.00 DHMEP35110 MEP Works in Risers& Clearance 5.00 15-Jan-15 20-Jan-15 23-Feb-15 28-Feb-15 -33.00 0% 0% 0.00 DHMEP35140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es07-Mar-15 12-Mar-15 25-Mar-15 01-Apr-15 -10.00 0% 0% 0.00 DHMEP35150 MEP Final Fixes 6.00 18-Aug-15 24-Aug-15 11-Oct-15 18-Oct-15 -9.00 0% 0% 0.00 DHMEP06470 Sanitary ware /Toilet accessories 6.00 22-Aug-15 27-Aug-15 15-Oct-15 21-Oct-15 -6.00 0% 0% 0.00 DHMEP35200 Pre-Testing & Commissioning 7.00 29-Aug-15 05-Sep-15 22-Oct-15 29-Oct-15 -6.00 0% 0% 0.00 LEVEL 36 401.00 09-Sep-14 05-Oct-15 15-Sep-14 A 03-Jan-16 -40.00 36.45% 31.42% 0.86 STRUCTURAL WORKS - LEVEL 36 21.00 09-Sep-14 29-Sep-14 15-Sep-14 A 01-Oct-14 -1.00 100% 86.19% 0.86 DHCWA37100 Core Wall - L36 7.00 09-Sep-14 16-Sep-14 15-Sep-14 A 17-Sep-14 A 100% 100% 1.00 DHSLA36100 Construction of Horizontals - L36 4.00 23-Sep-14 27-Sep-14 28-Sep-14 A 30-Sep-14 A 100% 100% 1.00 DHCWA37110 Construction of Verticals - L36 2.00 28-Sep-14 29-Sep-14 30-Sep-14 A 01-Oct-14 -1.00 100% 50% 0.50 STAIRCASES 4.00 26-Nov-14 30-Nov-14 01-Dec-14 06-Dec-14 41.00 0% 0% 0.00 A1900 Stair # 1 4.00 26-Nov-14 30-Nov-14 01-Dec-14 06-Dec-14 8.00 0% 0% 0.00 A1910 Stair # 2 4.00 26-Nov-14 30-Nov-14 01-Dec-14 06-Dec-14 41.00 0% 0% 0.00 FINISHES WORKS - LEVEL 36 335.00 19-Oct-14 05-Oct-15 22-Oct-14 26-Nov-15 -9.00 0% 0% 0.00 Dry area 294.00 18-Nov-14 19-Sep-15 26-Nov-14 12-Nov-15 -9.00 0% 0% 0.00 DHFSH36100 Block Work in Dry Area 6.00 18-Nov-14 24-Nov-14 26-Nov-14 03-Dec-14 -5.00 0% 0% 0.00 DHFSH36120 Marking,Cutting & Chasing - Dry Area 4.00 25-Nov-14 29-Nov-14 04-Dec-14 08-Dec-14 40.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Kitchen Cabinet Installation of Vanity Counters & Tops Installation of Shower Enclosure Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - L36 Construction of Horizontals - L36 Construction of Verticals - L36 Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 49 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 94.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH36130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 30-Nov-14 04-Dec-14 09-Dec-14 13-Dec-14 42.00 0% 0% 0.00 DHFSH36160 Plaster in Dry Area 8.00 08-Dec-14 16-Dec-14 16-Dec-14 24-Dec-14 40.00 0% 0% 0.00 DHMEP36190 Dry Area Floor Screed 7.00 17-Dec-14 24-Dec-14 25-Dec-14 03-Jan-15 40.00 0% 0% 0.00 DHFSH36230 Dry Area Painting - Primer 4.00 25-Dec-14 29-Dec-14 04-Jan-15 07-Jan-15 108.00 0% 0% 0.00 DHFSH36260 Dry Area Painting - Stucco 6.00 30-Dec-14 06-Jan-15 08-Jan-15 14-Jan-15 108.00 0% 0% 0.00 DHFSH36290 Dry Area False Ceiling Suspension 6.00 15-Jan-15 22-Jan-15 14-Mar-15 21-Mar-15 -23.00 0% 0% 0.00 DHFSH36350 Dry Area False Ceiling Tiling / Boarding 5.00 17-Mar-15 22-Mar-15 06-Apr-15 12-Apr-15 34.00 0% 0% 0.00 DHFSH36400 Dry Area Painting - 1st Coat 5.00 02-Apr-15 07-Apr-15 05-Jul-15 09-Jul-15 -37.00 0% 0% 0.00 DHFSH36450 Dry Area Flooring 5.00 19-Apr-15 23-Apr-15 20-Jul-15 25-Jul-15 -43.00 0% 0% 0.00 DHFSH36430 Installation of Timber Doors & Ironmongery 5.00 12-Aug-15 17-Aug-15 29-Aug-15 03-Sep-15 -14.00 0% 0% 0.00 DHFSH36802 Installation of Wardrobe 12.00 15-Aug-15 27-Aug-15 31-Aug-15 14-Sep-15 -14.00 0% 0% 0.00 DHFSH36500 Paint Final Coat 6.00 13-Sep-15 19-Sep-15 07-Nov-15 12-Nov-15 -9.00 0% 0% 0.00 Wet area 269.00 18-Nov-14 23-Aug-15 26-Nov-14 14-Oct-15 -35.00 0% 0% 0.00 DHFSH36110 Block Work in Wet Area 6.00 18-Nov-14 24-Nov-14 26-Nov-14 03-Dec-14 40.00 0% 0% 0.00 DHFSH36140 Marking,Cutting & Chasing - Wet Area 4.00 25-Nov-14 29-Nov-14 04-Dec-14 08-Dec-14 40.00 0% 0% 0.00 DHFSH36150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 30-Nov-14 04-Dec-14 09-Dec-14 13-Dec-14 50.00 0% 0% 0.00 DHMEP36170 Plaster in Wet Area 4.00 08-Dec-14 11-Dec-14 16-Dec-14 20-Dec-14 48.00 0% 0% 0.00 DHMEP36180 Wet Area Wall Tiling 6.00 11-Jan-15 18-Jan-15 15-Feb-15 21-Feb-15 1.00 0% 0% 0.00 DHFSH36300 Wet Area False Ceiling Suspension 5.00 22-Jan-15 28-Jan-15 21-Mar-15 26-Mar-15 -20.00 0% 0% 0.00 DHFSH36370 Wet Area False Ceiling Tiling/Boarding 4.00 17-Mar-15 21-Mar-15 06-Apr-15 11-Apr-15 3.00 0% 0% 0.00 DHFSH36210 Wet Area Waterproofing 4.00 22-Mar-15 25-Mar-15 11-Apr-15 15-Apr-15 3.00 0% 0% 0.00 DHFSH36220 Wet Area Floor Screed 4.00 26-Mar-15 30-Mar-15 15-Apr-15 20-Apr-15 3.00 0% 0% 0.00 DHFSH36250 Wet Area Floor Tiling 5.00 31-Mar-15 05-Apr-15 20-Apr-15 26-Apr-15 3.00 0% 0% 0.00 DHFSH06780 Cabinet Carcass 4.00 12-Apr-15 15-Apr-15 30-Apr-15 04-May-15 -1.00 0% 0% 0.00 DHFSH36800 Installation of Kitchen Cabinet 12.00 08-Aug-15 20-Aug-15 24-Aug-15 07-Sep-15 -14.00 0% 0% 0.00 DHFSH36390 Installation of Vanity Counters & Tops 5.00 18-Aug-15 23-Aug-15 03-Sep-15 09-Sep-15 -7.00 0% 0% 0.00 DHFSH36420 Installation of Shower Enclosure 4.00 17-Aug-15 20-Aug-15 10-Oct-15 14-Oct-15 -38.00 0% 0% 0.00 Lift Lobby / Corridor 183.00 25-Dec-14 24-Jun-15 04-Jan-15 08-Aug-15 60.00 0% 0% 0.00 DHFSH36240 Corridor/Lift Lobby Floor Screed 4.00 25-Dec-14 29-Dec-14 04-Jan-15 07-Jan-15 40.00 0% 0% 0.00 DHFSH36270 Lift Lobby Painting - Primer & Stucco 6.00 30-Dec-14 06-Jan-15 08-Jan-15 14-Jan-15 40.00 0% 0% 0.00 DHFSH36310 Lift Lobby False Ceiling Suspension 6.00 28-Jan-15 04-Feb-15 26-Mar-15 02-Apr-15 -20.00 0% 0% 0.00 DHFSH36360 Lift Lobby False Ceiling Tiling / Boarding 5.00 17-Mar-15 22-Mar-15 06-Apr-15 12-Apr-15 77.00 0% 0% 0.00 DHFSH36410 Lift Lobby Painting - 1st Coat 6.00 23-Mar-15 29-Mar-15 24-Jun-15 30-Jun-15 15.00 0% 0% 0.00 DHFSH36440 Installation of Steel Doors & Windows 3.00 22-Jun-15 24-Jun-15 14-Jul-15 16-Jul-15 -19.00 0% 0% 0.00 DHFSH36470 Lift Lobby Flooring 6.00 25-Apr-15 30-Apr-15 26-Jul-15 01-Aug-15 60.00 0% 0% 0.00 DHFSH36490 Utility Rooms- Epoxy Flooring 6.00 02-May-15 07-May-15 02-Aug-15 08-Aug-15 60.00 0% 0% 0.00 Staircase 180.00 17-Dec-14 02-Jul-15 25-Dec-14 27-Jul-15 13.00 0% 0% 0.00 DHFSH36200 Staircase Plastering 4.00 17-Dec-14 21-Dec-14 25-Dec-14 29-Dec-14 142.00 0% 0% 0.00 DHFSH36280 Staircase Painting - Primer & Stucco 6.00 07-Jan-15 13-Jan-15 15-Jan-15 21-Jan-15 129.00 0% 0% 0.00 DHFSH36320 Staircase Handrail Fixing 3.00 21-Mar-15 24-Mar-15 01-Feb-15 03-Feb-15 140.00 0% 0% 0.00 DHFSH36330 Staircase Painting 1st Coat 3.00 12-Apr-15 14-Apr-15 14-Jul-15 16-Jul-15 4.00 0% 0% 0.00 DHFSH36340 Staircase Final Painting 5.00 25-Jun-15 30-Jun-15 20-Jul-15 25-Jul-15 13.00 0% 0% 0.00 DHFSH36380 Staircase Epoxy Flooring 2.00 01-Jul-15 02-Jul-15 26-Jul-15 27-Jul-15 13.00 0% 0% 0.00 General 335.00 19-Oct-14 05-Oct-15 22-Oct-14 26-Nov-15 -9.00 0% 0% 0.00 DHSTR36000 Access from Structure 0.00 19-Oct-14 22-Oct-14 4.00 0% 0% 0.00 DHFSH36510 Snagging & De-Snagging 12.00 20-Sep-15 05-Oct-15 14-Nov-15 26-Nov-15 -9.00 0% 0% 0.00 MEP - LEVEL 36 379.00 24-Sep-14 12-Sep-15 28-Sep-14 A 03-Jan-16 -58.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Kitchen Cabinet Installation of Vanity Counters & Tops Installation of Shower Enclosure Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 50 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 95.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHMEP36000 Embeded Conduits & Boxex - Concrete Works 3.00 24-Sep-14 27-Sep-14 28-Sep-14 A 30-Sep-14 A 100% 100% 0.00 DHMEP36100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C28a-bOlicntg-1 ,4 Wiring et1c7-Nov-14 03-Nov-14 23-Nov-14 -5.00 0% 0% 0.00 DHMEP36130 Cable Trays & Cable Trunking 6.00 25-Nov-14 01-Dec-14 04-Dec-14 10-Dec-14 55.00 0% 0% 0.00 DHMEP36120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 30-Nov-14 07-Dec-14 09-Dec-14 15-Dec-14 40.00 0% 0% 0.00 DHMEP36160 Pressure Testing of Pipes 12.00 08-Dec-14 21-Dec-14 16-Dec-14 29-Dec-14 67.00 0% 0% 0.00 DHMEP36110 MEP Works in Risers& Clearance 5.00 21-Jan-15 26-Jan-15 01-Mar-15 05-Mar-15 -33.00 0% 0% 0.00 DHMEP36140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es10-Mar-15 16-Mar-15 30-Mar-15 06-Apr-15 -11.00 0% 0% 0.00 DHMEP36150 MEP Final Fixes 6.00 25-Aug-15 31-Aug-15 19-Oct-15 25-Oct-15 -9.00 0% 0% 0.00 DHMEP06550 Sanitary ware /Toilet accessories 6.00 29-Aug-15 03-Sep-15 22-Oct-15 28-Oct-15 -9.00 0% 0% 0.00 DHMEP36200 Pre-Testing & Commissioning 7.00 05-Sep-15 12-Sep-15 29-Oct-15 05-Nov-15 -9.00 0% 0% 0.00 DHMEP36010 Busbar - L36 to L40 10.00 28-Jun-15 08-Jul-15 23-Dec-15 03-Jan-16 -144.00 0% 0% 0.00 LEVEL 37 361.00 17-Sep-14 08-Oct-15 18-Sep-14 A 30-Nov-15 -9.00 17.63% 8.87% 0.50 STRUCTURAL WORKS - LEVEL 37 14.00 17-Sep-14 07-Oct-14 18-Sep-14 A 11-Oct-14 -2.00 48.36% 24.34% 0.50 DHCWA38100 Core Wall - L37 5.00 17-Sep-14 22-Sep-14 18-Sep-14 A 25-Sep-14 A 100% 100% 1.00 DHCWA38120 Tower Crane Jump 1.00 17-Sep-14 17-Sep-14 01-Oct-14 01-Oct-14 -4.00 100% 0% 0.00 DHSLA37100 Construction of Horizontals - L37 4.00 29-Sep-14 02-Oct-14 02-Oct-14 08-Oct-14 -2.00 50% 0% 0.00 DHCWA38110 Construction of Verticals - L37 2.00 06-Oct-14 07-Oct-14 09-Oct-14 11-Oct-14 -2.00 0% 0% 0.00 STAIRCASES 4.00 01-Dec-14 06-Dec-14 07-Dec-14 10-Dec-14 41.00 0% 0% 0.00 A1920 Stair # 1 4.00 01-Dec-14 06-Dec-14 07-Dec-14 10-Dec-14 8.00 0% 0% 0.00 A1930 Stair # 2 4.00 01-Dec-14 06-Dec-14 07-Dec-14 10-Dec-14 41.00 0% 0% 0.00 FINISHES WORKS - LEVEL 37 333.00 26-Oct-14 08-Oct-15 29-Oct-14 30-Nov-15 -9.00 0% 0% 0.00 Dry area 293.00 24-Nov-14 22-Sep-15 01-Dec-14 16-Nov-15 -9.00 0% 0% 0.00 DHFSH37100 Block Work in Dry Area 6.00 24-Nov-14 30-Nov-14 01-Dec-14 08-Dec-14 -5.00 0% 0% 0.00 DHFSH37120 Marking,Cutting & Chasing - Dry Area 4.00 01-Dec-14 06-Dec-14 09-Dec-14 13-Dec-14 39.00 0% 0% 0.00 DHFSH37130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 07-Dec-14 10-Dec-14 14-Dec-14 17-Dec-14 41.00 0% 0% 0.00 DHFSH37160 Plaster in Dry Area 8.00 14-Dec-14 22-Dec-14 21-Dec-14 29-Dec-14 39.00 0% 0% 0.00 DHMEP37190 Dry Area Floor Screed 7.00 23-Dec-14 30-Dec-14 30-Dec-14 07-Jan-15 39.00 0% 0% 0.00 DHFSH37230 Dry Area Painting - Primer 4.00 31-Dec-14 05-Jan-15 08-Jan-15 12-Jan-15 108.00 0% 0% 0.00 DHFSH37260 Dry Area Painting - Stucco 6.00 06-Jan-15 12-Jan-15 13-Jan-15 19-Jan-15 108.00 0% 0% 0.00 DHFSH37290 Dry Area False Ceiling Suspension 6.00 20-Jan-15 27-Jan-15 18-Mar-15 25-Mar-15 -23.00 0% 0% 0.00 DHFSH37350 Dry Area False Ceiling Tiling / Boarding 5.00 21-Mar-15 25-Mar-15 11-Apr-15 16-Apr-15 34.00 0% 0% 0.00 DHFSH37400 Dry Area Painting - 1st Coat 5.00 06-Apr-15 11-Apr-15 08-Jul-15 13-Jul-15 -36.00 0% 0% 0.00 DHFSH37450 Dry Area Flooring 5.00 23-Apr-15 28-Apr-15 25-Jul-15 29-Jul-15 -43.00 0% 0% 0.00 DHFSH37430 Installation of Timber Doors & Ironmongery 5.00 18-Aug-15 23-Aug-15 03-Sep-15 09-Sep-15 -14.00 0% 0% 0.00 DHFSH37802 Installation of Wardrobe 12.00 22-Aug-15 03-Sep-15 07-Sep-15 21-Sep-15 -14.00 0% 0% 0.00 DHFSH37500 Paint Final Coat 6.00 16-Sep-15 22-Sep-15 10-Nov-15 16-Nov-15 -9.00 0% 0% 0.00 Wet area 268.00 24-Nov-14 29-Aug-15 01-Dec-14 18-Oct-15 -35.00 0% 0% 0.00 DHFSH37110 Block Work in Wet Area 6.00 24-Nov-14 30-Nov-14 01-Dec-14 08-Dec-14 39.00 0% 0% 0.00 DHFSH37140 Marking,Cutting & Chasing - Wet Area 4.00 01-Dec-14 06-Dec-14 09-Dec-14 13-Dec-14 39.00 0% 0% 0.00 DHFSH37150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 07-Dec-14 10-Dec-14 14-Dec-14 17-Dec-14 50.00 0% 0% 0.00 DHMEP37170 Plaster in Wet Area 4.00 14-Dec-14 17-Dec-14 21-Dec-14 24-Dec-14 48.00 0% 0% 0.00 DHMEP37180 Wet Area Wall Tiling 6.00 15-Jan-15 22-Jan-15 19-Feb-15 25-Feb-15 1.00 0% 0% 0.00 DHFSH37300 Wet Area False Ceiling Suspension 5.00 27-Jan-15 02-Feb-15 25-Mar-15 31-Mar-15 -21.00 0% 0% 0.00 DHFSH37370 Wet Area False Ceiling Tiling/Boarding 4.00 21-Mar-15 24-Mar-15 11-Apr-15 15-Apr-15 3.00 0% 0% 0.00 DHMEP37210 Wet Area Waterproofing 4.00 25-Mar-15 29-Mar-15 15-Apr-15 20-Apr-15 3.00 0% 0% 0.00 DHFSH37220 Wet Area Floor Screed 4.00 30-Mar-15 02-Apr-15 20-Apr-15 25-Apr-15 3.00 0% 0% 0.00 DHFSH37250 Wet Area Floor Tiling 5.00 04-Apr-15 08-Apr-15 25-Apr-15 30-Apr-15 3.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - L37 Tower Crane Jump Construction of Horizontals - L37 Construction of Verticals - L37 Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 51 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 96.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHFSH06790 Cabinet Carcass 4.00 16-Apr-15 20-Apr-15 05-May-15 09-May-15 -1.00 0% 0% 0.00 DHFSH37800 Installation of Kitchen Cabinet 12.00 15-Aug-15 27-Aug-15 31-Aug-15 14-Sep-15 -14.00 0% 0% 0.00 DHFSH37390 Installation of Vanity Counters & Tops 5.00 24-Aug-15 29-Aug-15 09-Sep-15 15-Sep-15 -9.00 0% 0% 0.00 DHFSH37420 Installation of Shower Enclosure 4.00 23-Aug-15 26-Aug-15 14-Oct-15 18-Oct-15 -38.00 0% 0% 0.00 Lift Lobby / Corridor 181.00 31-Dec-14 28-Jun-15 08-Jan-15 10-Aug-15 60.00 0% 0% 0.00 DHFSH37240 Corridor/Lift Lobby Floor Screed 4.00 31-Dec-14 05-Jan-15 08-Jan-15 12-Jan-15 39.00 0% 0% 0.00 DHFSH37270 Lift Lobby Painting - Primer & Stucco 6.00 06-Jan-15 12-Jan-15 13-Jan-15 19-Jan-15 39.00 0% 0% 0.00 DHFSH37310 Lift Lobby False Ceiling Suspension 6.00 02-Feb-15 09-Feb-15 31-Mar-15 07-Apr-15 -21.00 0% 0% 0.00 DHFSH37360 Lift Lobby False Ceiling Tiling / Boarding 5.00 21-Mar-15 25-Mar-15 11-Apr-15 16-Apr-15 76.00 0% 0% 0.00 DHFSH37410 Lift Lobby Painting - 1st Coat 6.00 26-Mar-15 01-Apr-15 28-Jun-15 04-Jul-15 15.00 0% 0% 0.00 DHFSH37440 Installation of Steel Doors & Windows 3.00 25-Jun-15 28-Jun-15 20-Jul-15 22-Jul-15 -19.00 0% 0% 0.00 DHFSH37470 Lift Lobby Flooring 6.00 29-Apr-15 05-May-15 30-Jul-15 05-Aug-15 61.00 0% 0% 0.00 DHFSH37490 Utility Rooms- Epoxy Flooring 6.00 04-May-15 10-May-15 04-Aug-15 10-Aug-15 60.00 0% 0% 0.00 Staircase 180.00 23-Dec-14 06-Jul-15 30-Dec-14 01-Aug-15 14.00 0% 0% 0.00 DHFSH37200 Staircase Plastering 4.00 23-Dec-14 27-Dec-14 30-Dec-14 04-Jan-15 141.00 0% 0% 0.00 DHFSH37280 Staircase Painting - Primer & Stucco 6.00 13-Jan-15 19-Jan-15 20-Jan-15 26-Jan-15 128.00 0% 0% 0.00 DHFSH37320 Staircase Handrail Fixing 3.00 24-Mar-15 28-Mar-15 04-Feb-15 07-Feb-15 140.00 0% 0% 0.00 DHFSH37330 Staircase Painting 1st Coat 3.00 15-Apr-15 18-Apr-15 20-Jul-15 22-Jul-15 4.00 0% 0% 0.00 DHFSH37340 Staircase Final Painting 5.00 29-Jun-15 04-Jul-15 23-Jul-15 28-Jul-15 15.00 0% 0% 0.00 DHFSH37380 Staircase Epoxy Flooring 2.00 05-Jul-15 06-Jul-15 30-Jul-15 01-Aug-15 14.00 0% 0% 0.00 General 333.00 26-Oct-14 08-Oct-15 29-Oct-14 30-Nov-15 -9.00 0% 0% 0.00 DHSTR37000 Access from Structure 0.00 26-Oct-14 29-Oct-14 4.00 0% 0% 0.00 DHFSH37510 Snagging & De-Snagging 12.00 26-Sep-15 08-Oct-15 17-Nov-15 30-Nov-15 -9.00 0% 0% 0.00 MEP - LEVEL 37 334.00 30-Sep-14 15-Sep-15 06-Oct-14 09-Nov-15 -9.00 0% 0% 0.00 DHMEP37000 Embeded Conduits & Boxex - Concrete Works 3.00 30-Sep-14 02-Oct-14 06-Oct-14 08-Oct-14 20.00 33.33% 0% 0.00 DHMEP37100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C03a-bNlionvg- 1, 4Wiring et2c3-Nov-14 09-Nov-14 29-Nov-14 -5.00 0% 0% 0.00 DHMEP37130 Cable Trays & Cable Trunking 6.00 01-Dec-14 08-Dec-14 09-Dec-14 15-Dec-14 55.00 0% 0% 0.00 DHMEP37120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 07-Dec-14 13-Dec-14 14-Dec-14 20-Dec-14 39.00 0% 0% 0.00 DHMEP37160 Pressure Testing of Pipes 12.00 14-Dec-14 27-Dec-14 21-Dec-14 04-Jan-15 66.00 0% 0% 0.00 DHMEP37110 MEP Works in Risers& Clearance 5.00 27-Jan-15 01-Feb-15 07-Mar-15 11-Mar-15 -33.00 0% 0% 0.00 DHMEP37140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es14-Mar-15 19-Mar-15 04-Apr-15 11-Apr-15 -12.00 0% 0% 0.00 DHMEP37150 MEP Final Fixes 6.00 29-Aug-15 03-Sep-15 22-Oct-15 28-Oct-15 -9.00 0% 0% 0.00 DHMEP06580 Sanitary ware /Toilet accessories 6.00 01-Sep-15 07-Sep-15 26-Oct-15 01-Nov-15 -9.00 0% 0% 0.00 DHMEP37200 Pre-Testing & Commissioning 7.00 08-Sep-15 15-Sep-15 02-Nov-15 09-Nov-15 -9.00 0% 0% 0.00 LEVEL 38 362.00 23-Sep-14 12-Oct-15 27-Sep-14 A 05-Dec-15 -9.00 8.88% 8.88% 1.00 STRUCTURAL WORKS - LEVEL 38 15.00 23-Sep-14 11-Oct-14 27-Sep-14 A 14-Oct-14 -2.00 24.38% 24.38% 1.00 DHCWA39100 Core Wall - L38 4.00 23-Sep-14 27-Sep-14 27-Sep-14 A 29-Sep-14 A 100% 100% 1.00 DHSLA38100 Construction of Horizontals - L38 3.00 06-Oct-14 08-Oct-14 09-Oct-14 12-Oct-14 -2.00 0% 0% 0.00 DHCWA39110 Construction of Verticals - L38 2.00 09-Oct-14 11-Oct-14 13-Oct-14 14-Oct-14 -2.00 0% 0% 0.00 STAIRCASES 4.00 07-Dec-14 10-Dec-14 11-Dec-14 15-Dec-14 41.00 0% 0% 0.00 A1940 Stair # 1 4.00 07-Dec-14 10-Dec-14 11-Dec-14 15-Dec-14 8.00 0% 0% 0.00 A1950 Stair # 2 4.00 07-Dec-14 10-Dec-14 11-Dec-14 15-Dec-14 41.00 0% 0% 0.00 FINISHES WORKS - LEVEL 38 331.00 30-Oct-14 12-Oct-15 04-Nov-14 05-Dec-15 -9.00 0% 0% 0.00 Dry area 290.00 01-Dec-14 28-Sep-15 09-Dec-14 19-Nov-15 -9.00 0% 0% 0.00 DHFSH38100 Block Work in Dry Area 6.00 01-Dec-14 08-Dec-14 09-Dec-14 15-Dec-14 -5.00 0% 0% 0.00 DHFSH38120 Marking,Cutting & Chasing - Dry Area 4.00 09-Dec-14 13-Dec-14 16-Dec-14 20-Dec-14 36.00 0% 0% 0.00 DHFSH38130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 14-Dec-14 17-Dec-14 21-Dec-14 24-Dec-14 38.00 0% 0% 0.00 DHFSH38160 Plaster in Dry Area 8.00 21-Dec-14 29-Dec-14 28-Dec-14 06-Jan-15 36.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Cabinet Carcass Installation of Kitchen Cabinet Installation of Vanity Counters & Tops Installation of Shower Enclosure Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - L38 Construction of Horizontals - L38 Construction of Verticals - L38 Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 52 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 97.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHMEP38190 Dry Area Floor Screed 7.00 30-Dec-14 07-Jan-15 07-Jan-15 14-Jan-15 36.00 0% 0% 0.00 DHFSH38230 Dry Area Painting - Primer 4.00 08-Jan-15 12-Jan-15 15-Jan-15 19-Jan-15 147.00 0% 0% 0.00 DHFSH38260 Dry Area Painting - Stucco 6.00 13-Jan-15 19-Jan-15 20-Jan-15 26-Jan-15 147.00 0% 0% 0.00 DHFSH38290 Dry Area False Ceiling Suspension 6.00 25-Jan-15 01-Feb-15 23-Mar-15 30-Mar-15 -23.00 0% 0% 0.00 DHFSH38350 Dry Area False Ceiling Tiling / Boarding 5.00 24-Mar-15 29-Mar-15 15-Apr-15 21-Apr-15 34.00 0% 0% 0.00 DHFSH38400 Dry Area Painting - 1st Coat 5.00 09-Apr-15 14-Apr-15 12-Jul-15 16-Jul-15 -35.00 0% 0% 0.00 DHFSH38450 Dry Area Flooring 5.00 28-Apr-15 03-May-15 29-Jul-15 03-Aug-15 -43.00 0% 0% 0.00 DHFSH38430 Installation of Timber Doors & Ironmongery 5.00 22-Aug-15 26-Aug-15 07-Sep-15 13-Sep-15 -14.00 0% 0% 0.00 DHFSH38802 Installation of Wardrobe 12.00 29-Aug-15 10-Sep-15 14-Sep-15 30-Sep-15 -14.00 0% 0% 0.00 DHFSH38500 Paint Final Coat 6.00 20-Sep-15 28-Sep-15 14-Nov-15 19-Nov-15 -9.00 0% 0% 0.00 Wet area 265.00 01-Dec-14 03-Sep-15 09-Dec-14 21-Oct-15 -35.00 0% 0% 0.00 DHFSH38110 Block Work in Wet Area 6.00 01-Dec-14 08-Dec-14 09-Dec-14 15-Dec-14 36.00 0% 0% 0.00 DHFSH38140 Marking,Cutting & Chasing - Wet Area 4.00 09-Dec-14 13-Dec-14 16-Dec-14 20-Dec-14 36.00 0% 0% 0.00 DHFSH38150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 14-Dec-14 17-Dec-14 21-Dec-14 24-Dec-14 48.00 0% 0% 0.00 DHMEP38170 Plaster in Wet Area 4.00 21-Dec-14 24-Dec-14 28-Dec-14 31-Dec-14 46.00 0% 0% 0.00 DHMEP38180 Wet Area Wall Tiling 6.00 20-Jan-15 27-Jan-15 24-Feb-15 02-Mar-15 1.00 0% 0% 0.00 DHFSH38300 Wet Area False Ceiling Suspension 5.00 01-Feb-15 07-Feb-15 30-Mar-15 05-Apr-15 -22.00 0% 0% 0.00 DHFSH38370 Wet Area False Ceiling Tiling/Boarding 4.00 24-Mar-15 28-Mar-15 15-Apr-15 20-Apr-15 3.00 0% 0% 0.00 DHMEP38210 Wet Area Waterproofing 4.00 29-Mar-15 01-Apr-15 20-Apr-15 25-Apr-15 3.00 0% 0% 0.00 DHFSH38220 Wet Area Floor Screed 4.00 02-Apr-15 06-Apr-15 25-Apr-15 29-Apr-15 3.00 0% 0% 0.00 DHFSH38250 Wet Area Floor Tiling 5.00 07-Apr-15 12-Apr-15 29-Apr-15 05-May-15 3.00 0% 0% 0.00 DHFSH06810 Cabinet Carcass 4.00 21-Apr-15 25-Apr-15 10-May-15 13-May-15 -1.00 0% 0% 0.00 DHFSH38390 Installation of Vanity Counters & Tops 5.00 27-Aug-15 01-Sep-15 13-Sep-15 19-Sep-15 -9.00 0% 0% 0.00 DHFSH38800 Installation of Kitchen Cabinet 12.00 22-Aug-15 03-Sep-15 07-Sep-15 21-Sep-15 -14.00 0% 0% 0.00 DHFSH38420 Installation of Shower Enclosure 4.00 26-Aug-15 30-Aug-15 18-Oct-15 21-Oct-15 -38.00 0% 0% 0.00 Lift Lobby / Corridor 181.00 08-Jan-15 01-Jul-15 15-Jan-15 17-Aug-15 56.00 0% 0% 0.00 DHFSH38240 Corridor/Lift Lobby Floor Screed 4.00 08-Jan-15 12-Jan-15 15-Jan-15 19-Jan-15 36.00 0% 0% 0.00 DHFSH38270 Lift Lobby Painting - Primer & Stucco 6.00 13-Jan-15 19-Jan-15 20-Jan-15 26-Jan-15 36.00 0% 0% 0.00 DHFSH38310 Lift Lobby False Ceiling Suspension 6.00 07-Feb-15 14-Feb-15 05-Apr-15 12-Apr-15 -22.00 0% 0% 0.00 DHFSH38360 Lift Lobby False Ceiling Tiling / Boarding 5.00 24-Mar-15 29-Mar-15 15-Apr-15 21-Apr-15 75.00 0% 0% 0.00 DHFSH38410 Lift Lobby Painting - 1st Coat 6.00 30-Mar-15 05-Apr-15 01-Jul-15 07-Jul-15 15.00 0% 0% 0.00 DHFSH38440 Installation of Steel Doors & Windows 3.00 29-Jun-15 01-Jul-15 23-Jul-15 26-Jul-15 -19.00 0% 0% 0.00 DHFSH38470 Lift Lobby Flooring 6.00 04-May-15 10-May-15 04-Aug-15 10-Aug-15 56.00 0% 0% 0.00 DHFSH38490 Utility Rooms- Epoxy Flooring 6.00 11-May-15 18-May-15 11-Aug-15 17-Aug-15 56.00 0% 0% 0.00 Staircase 178.00 30-Dec-14 09-Jul-15 07-Jan-15 05-Aug-15 13.00 0% 0% 0.00 DHFSH38200 Staircase Plastering 4.00 30-Dec-14 04-Jan-15 07-Jan-15 11-Jan-15 138.00 0% 0% 0.00 DHFSH38280 Staircase Painting - Primer & Stucco 6.00 20-Jan-15 26-Jan-15 27-Jan-15 02-Feb-15 125.00 0% 0% 0.00 DHFSH38320 Staircase Handrail Fixing 3.00 28-Mar-15 31-Mar-15 08-Feb-15 10-Feb-15 140.00 0% 0% 0.00 DHFSH38330 Staircase Painting 1st Coat 3.00 19-Apr-15 21-Apr-15 23-Jul-15 26-Jul-15 4.00 0% 0% 0.00 DHFSH38340 Staircase Final Painting 5.00 02-Jul-15 07-Jul-15 27-Jul-15 01-Aug-15 15.00 0% 0% 0.00 DHFSH38380 Staircase Epoxy Flooring 2.00 08-Jul-15 09-Jul-15 04-Aug-15 05-Aug-15 13.00 0% 0% 0.00 General 331.00 30-Oct-14 12-Oct-15 04-Nov-14 05-Dec-15 -9.00 0% 0% 0.00 DHSTR38000 Access from Structure 0.00 30-Oct-14 04-Nov-14 4.00 0% 0% 0.00 DHFSH38510 Snagging & De-Snagging 12.00 29-Sep-15 12-Oct-15 21-Nov-15 05-Dec-15 -9.00 0% 0% 0.00 MEP - LEVEL 38 333.00 07-Oct-14 19-Sep-15 11-Oct-14 12-Nov-15 -9.00 0% 0% 0.00 DHMEP38000 Embeded Conduits & Boxex - Concrete Works 3.00 07-Oct-14 09-Oct-14 11-Oct-14 13-Oct-14 21.00 0% 0% 0.00 DHMEP38100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C09a-bNlionvg- 1, 4Wiring et2c9-Nov-14 15-Nov-14 06-Dec-14 -5.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Installation of Shower Enclosure Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 53 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 98.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHMEP38130 Cable Trays & Cable Trunking 6.00 09-Dec-14 15-Dec-14 16-Dec-14 22-Dec-14 53.00 0% 0% 0.00 DHMEP38120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 14-Dec-14 20-Dec-14 21-Dec-14 27-Dec-14 36.00 0% 0% 0.00 DHMEP38160 Pressure Testing of Pipes 12.00 21-Dec-14 04-Jan-15 28-Dec-14 11-Jan-15 63.00 0% 0% 0.00 DHMEP38110 MEP Works in Risers& Clearance 5.00 02-Feb-15 07-Feb-15 12-Mar-15 17-Mar-15 -33.00 0% 0% 0.00 DHMEP38140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es17-Mar-15 23-Mar-15 08-Apr-15 15-Apr-15 -13.00 0% 0% 0.00 DHMEP38150 MEP Final Fixes 6.00 01-Sep-15 07-Sep-15 26-Oct-15 01-Nov-15 -9.00 0% 0% 0.00 DHMEP06560 Sanitary ware /Toilet accessories 6.00 05-Sep-15 10-Sep-15 29-Oct-15 04-Nov-15 -9.00 0% 0% 0.00 DHMEP38200 Pre-Testing & Commissioning 7.00 12-Sep-15 19-Sep-15 05-Nov-15 12-Nov-15 -9.00 0% 0% 0.00 LEVEL 39 361.00 28-Sep-14 17-Oct-15 30-Sep-14 A 08-Dec-15 -9.00 6.65% 0% 0.00 STRUCTURAL WORKS - LEVEL 39 15.00 28-Sep-14 15-Oct-14 30-Sep-14 A 19-Oct-14 -2.00 18.25% 0% 0.00 DHCWA40100 Core Wall - L39 4.00 28-Sep-14 01-Oct-14 30-Sep-14 A 08-Oct-14 -4.00 75% 0% 0.00 DHSLA39100 Construction of Horizontals - L39 4.00 09-Oct-14 13-Oct-14 13-Oct-14 16-Oct-14 -2.00 0% 0% 0.00 DHCWA40110 Construction of Verticals - L39 2.00 14-Oct-14 15-Oct-14 18-Oct-14 19-Oct-14 -2.00 0% 0% 0.00 STAIRCASES 4.00 11-Dec-14 15-Dec-14 16-Dec-14 20-Dec-14 41.00 0% 0% 0.00 A1960 Stair # 1 4.00 11-Dec-14 15-Dec-14 16-Dec-14 20-Dec-14 8.00 0% 0% 0.00 A1970 Stair # 2 4.00 11-Dec-14 15-Dec-14 16-Dec-14 20-Dec-14 41.00 0% 0% 0.00 FINISHES WORKS - LEVEL 39 329.00 05-Nov-14 17-Oct-15 10-Nov-14 08-Dec-15 -9.00 0% 0% 0.00 Dry area 289.00 07-Dec-14 01-Oct-15 14-Dec-14 23-Nov-15 -9.00 0% 0% 0.00 DHFSH39100 Block Work in Dry Area 6.00 07-Dec-14 13-Dec-14 14-Dec-14 20-Dec-14 -5.00 0% 0% 0.00 DHFSH39120 Marking,Cutting & Chasing - Dry Area 4.00 14-Dec-14 17-Dec-14 21-Dec-14 24-Dec-14 35.00 0% 0% 0.00 DHFSH39130 Sub frame Fixing/Plaster Preparation - Dry Area 4.00 18-Dec-14 22-Dec-14 25-Dec-14 29-Dec-14 37.00 0% 0% 0.00 DHFSH39160 Plaster in Dry Area 8.00 25-Dec-14 04-Jan-15 03-Jan-15 11-Jan-15 35.00 0% 0% 0.00 DHFSH39190 Dry Area Floor Screed 7.00 05-Jan-15 12-Jan-15 12-Jan-15 19-Jan-15 35.00 0% 0% 0.00 DHFSH39230 Dry Area Painting - Primer 4.00 13-Jan-15 17-Jan-15 20-Jan-15 24-Jan-15 106.00 0% 0% 0.00 DHFSH39260 Dry Area Painting - Stucco 6.00 18-Jan-15 24-Jan-15 25-Jan-15 31-Jan-15 106.00 0% 0% 0.00 DHFSH39290 Dry Area False Ceiling Suspension 6.00 29-Jan-15 05-Feb-15 28-Mar-15 04-Apr-15 -23.00 0% 0% 0.00 DHFSH39350 Dry Area False Ceiling Tiling / Boarding 5.00 28-Mar-15 01-Apr-15 20-Apr-15 26-Apr-15 34.00 0% 0% 0.00 DHFSH39400 Dry Area Painting - 1st Coat 5.00 13-Apr-15 18-Apr-15 15-Jul-15 22-Jul-15 -34.00 0% 0% 0.00 DHFSH39450 Dry Area Flooring 5.00 03-May-15 07-May-15 03-Aug-15 08-Aug-15 -43.00 0% 0% 0.00 DHFSH39430 Installation of Timber Doors & Ironmongery 5.00 25-Aug-15 30-Aug-15 10-Sep-15 16-Sep-15 -14.00 0% 0% 0.00 DHFSH39802 Installation of Wardrobe 12.00 02-Sep-15 15-Sep-15 19-Sep-15 05-Oct-15 -14.00 0% 0% 0.00 DHFSH39500 Paint Final Coat 6.00 26-Sep-15 01-Oct-15 17-Nov-15 23-Nov-15 -9.00 0% 0% 0.00 Wet area 264.00 07-Dec-14 07-Sep-15 14-Dec-14 25-Oct-15 -35.00 0% 0% 0.00 DHFSH39110 Block Work in Wet Area 6.00 07-Dec-14 13-Dec-14 14-Dec-14 20-Dec-14 35.00 0% 0% 0.00 DHFSH39140 Marking,Cutting & Chasing - Wet Area 4.00 14-Dec-14 17-Dec-14 21-Dec-14 24-Dec-14 35.00 0% 0% 0.00 DHFSH39150 Sub frame Fixing/Plaster Preparation - Wet Area 4.00 18-Dec-14 22-Dec-14 25-Dec-14 29-Dec-14 48.00 0% 0% 0.00 DHFSH39170 Plaster in Wet Area 4.00 25-Dec-14 29-Dec-14 03-Jan-15 06-Jan-15 46.00 0% 0% 0.00 DHFSH39180 Wet Area Wall Tiling 6.00 25-Jan-15 01-Feb-15 01-Mar-15 07-Mar-15 1.00 0% 0% 0.00 DHFSH39300 Wet Area False Ceiling Suspension 5.00 05-Feb-15 11-Feb-15 04-Apr-15 09-Apr-15 -23.00 0% 0% 0.00 DHFSH39370 Wet Area False Ceiling Tiling/Boarding 4.00 28-Mar-15 31-Mar-15 20-Apr-15 25-Apr-15 3.00 0% 0% 0.00 DHFSH39210 Wet Area Waterproofing 4.00 01-Apr-15 05-Apr-15 25-Apr-15 29-Apr-15 3.00 0% 0% 0.00 DHFSH39220 Wet Area Floor Screed 4.00 06-Apr-15 09-Apr-15 29-Apr-15 04-May-15 3.00 0% 0% 0.00 DHFSH39250 Wet Area Floor Tiling 5.00 11-Apr-15 15-Apr-15 04-May-15 10-May-15 3.00 0% 0% 0.00 DHFSH06820 Cabinet Carcass 4.00 26-Apr-15 29-Apr-15 14-May-15 19-May-15 -1.00 0% 0% 0.00 DHFSH39390 Installation of Vanity Counters & Tops 5.00 31-Aug-15 05-Sep-15 16-Sep-15 22-Sep-15 -9.00 0% 0% 0.00 DHFSH39800 Installation of Kitchen Cabinet 12.00 25-Aug-15 07-Sep-15 10-Sep-15 27-Sep-15 -14.00 0% 0% 0.00 DHFSH39420 Installation of Shower Enclosure 4.00 30-Aug-15 02-Sep-15 21-Oct-15 25-Oct-15 -38.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning Core Wall - L39 Construction of Horizontals - L39 Construction of Verticals - L39 Stair # 1 Stair # 2 Block Work in Dry Area Marking,Cutting & Chasing - Dry Area Sub frame Fixing/Plaster Preparation - Dry Area Plaster in Dry Area Dry Area Floor Screed Dry Area Painting - Primer Dry Area Painting - Stucco Dry Area False Ceiling Suspension Dry Area False Ceiling Tiling / Boarding Dry Area Painting - 1st Coat Dry Area Flooring Installation of Timber Doors & Ironmongery Installation of Wardrobe Paint Final Coat Block Work in Wet Area Marking,Cutting & Chasing - Wet Area Sub frame Fixing/Plaster Preparation - Wet Area Plaster in Wet Area Wet Area Wall Tiling Wet Area False Ceiling Suspension Wet Area False Ceiling Tiling/Boarding Wet Area Waterproofing Wet Area Floor Screed Wet Area Floor Tiling Cabinet Carcass Installation of Vanity Counters & Tops Installation of Kitchen Cabinet Installation of Shower Enclosure DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 54 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 99.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 Lift Lobby / Corridor 181.00 13-Jan-15 05-Jul-15 20-Jan-15 22-Aug-15 54.00 0% 0% 0.00 DHFSH39240 Corridor/Lift Lobby Floor Screed 4.00 13-Jan-15 17-Jan-15 20-Jan-15 24-Jan-15 35.00 0% 0% 0.00 DHFSH39270 Lift Lobby Painting - Primer & Stucco 6.00 18-Jan-15 24-Jan-15 25-Jan-15 31-Jan-15 35.00 0% 0% 0.00 DHFSH39310 Lift Lobby False Ceiling Suspension 6.00 11-Feb-15 18-Feb-15 09-Apr-15 16-Apr-15 -23.00 0% 0% 0.00 DHFSH39360 Lift Lobby False Ceiling Tiling / Boarding 5.00 28-Mar-15 01-Apr-15 20-Apr-15 26-Apr-15 74.00 0% 0% 0.00 DHFSH39410 Lift Lobby Painting - 1st Coat 6.00 02-Apr-15 08-Apr-15 05-Jul-15 11-Jul-15 15.00 0% 0% 0.00 DHFSH39440 Installation of Steel Doors & Windows 3.00 02-Jul-15 05-Jul-15 27-Jul-15 29-Jul-15 -19.00 0% 0% 0.00 DHFSH39470 Lift Lobby Flooring 6.00 09-May-15 14-May-15 09-Aug-15 15-Aug-15 54.00 0% 0% 0.00 DHFSH39490 Utility Rooms- Epoxy Flooring 6.00 17-May-15 23-May-15 16-Aug-15 22-Aug-15 54.00 0% 0% 0.00 Staircase 178.00 05-Jan-15 13-Jul-15 12-Jan-15 10-Aug-15 12.00 0% 0% 0.00 DHFSH39200 Staircase Plastering 4.00 05-Jan-15 08-Jan-15 12-Jan-15 15-Jan-15 137.00 0% 0% 0.00 DHFSH39280 Staircase Painting - Primer & Stucco 6.00 25-Jan-15 31-Jan-15 01-Feb-15 07-Feb-15 124.00 0% 0% 0.00 DHFSH39320 Staircase Handrail Fixing 3.00 31-Mar-15 04-Apr-15 11-Feb-15 14-Feb-15 140.00 0% 0% 0.00 DHFSH39330 Staircase Painting 1st Coat 3.00 22-Apr-15 25-Apr-15 27-Jul-15 29-Jul-15 4.00 0% 0% 0.00 DHFSH39340 Staircase Final Painting 5.00 06-Jul-15 11-Jul-15 30-Jul-15 04-Aug-15 15.00 0% 0% 0.00 DHFSH39380 Staircase Epoxy Flooring 2.00 12-Jul-15 13-Jul-15 09-Aug-15 10-Aug-15 12.00 0% 0% 0.00 General 329.00 05-Nov-14 17-Oct-15 10-Nov-14 08-Dec-15 -9.00 0% 0% 0.00 DHSTR39000 Access from Structure 0.00 05-Nov-14 10-Nov-14 4.00 0% 0% 0.00 DHFSH39510 Snagging & De-Snagging 12.00 03-Oct-15 17-Oct-15 24-Nov-15 08-Dec-15 -9.00 0% 0% 0.00 MEP - LEVEL 39 333.00 11-Oct-14 22-Sep-15 14-Oct-14 16-Nov-15 -9.00 0% 0% 0.00 DHMEP39000 Embeded Conduits & Boxex - Concrete Works 3.00 11-Oct-14 13-Oct-14 14-Oct-14 16-Oct-14 23.00 0% 0% 0.00 DHMEP39100 H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Du1c8t.i0n0g, C15a-bNlionvg- 1, 4Wiring et0c6-Dec-14 20-Nov-14 11-Dec-14 -5.00 0% 0% 0.00 DHMEP39130 Cable Trays & Cable Trunking 6.00 14-Dec-14 20-Dec-14 21-Dec-14 27-Dec-14 53.00 0% 0% 0.00 DHMEP39120 Embeded Condiuts,Boxes and Sleeves in Walls 6.00 18-Dec-14 24-Dec-14 25-Dec-14 31-Dec-14 35.00 0% 0% 0.00 DHMEP39160 Pressure Testing of Pipes 12.00 25-Dec-14 08-Jan-15 03-Jan-15 15-Jan-15 62.00 0% 0% 0.00 DHMEP39110 MEP Works in Risers& Clearance 5.00 08-Feb-15 12-Feb-15 18-Mar-15 23-Mar-15 -33.00 0% 0% 0.00 DHMEP39140 Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd6 .f0ix0es21-Mar-15 26-Mar-15 13-Apr-15 20-Apr-15 -14.00 0% 0% 0.00 DHMEP39150 MEP Final Fixes 6.00 05-Sep-15 10-Sep-15 29-Oct-15 04-Nov-15 -9.00 0% 0% 0.00 DHMEP06570 Sanitary ware /Toilet accessories 6.00 08-Sep-15 14-Sep-15 02-Nov-15 08-Nov-15 -9.00 0% 0% 0.00 DHMEP39200 Pre-Testing & Commissioning 7.00 15-Sep-15 22-Sep-15 09-Nov-15 16-Nov-15 -9.00 0% 0% 0.00 LEVEL 40 358.00 02-Oct-14 20-Oct-15 09-Oct-14 12-Dec-15 -9.00 0% 0% 0.00 LEVEL 41 383.00 09-Oct-14 24-Oct-15 14-Oct-14 14-Jan-16 -35.00 0% 0% 0.00 LEVEL 42 356.00 14-Oct-14 27-Oct-15 19-Oct-14 19-Dec-15 -9.00 0% 0% 0.00 LEVEL 43 354.00 20-Oct-14 31-Oct-15 26-Oct-14 22-Dec-15 -9.00 0% 0% 0.00 LEVEL 44 353.00 26-Oct-14 04-Nov-15 30-Oct-14 26-Dec-15 -9.00 0% 0% 0.00 LEVEL 45 355.00 30-Oct-14 11-Nov-15 04-Nov-14 02-Jan-16 -9.00 0% 0% 0.00 LEVEL 46 372.00 04-Nov-14 16-Nov-15 09-Nov-14 26-Jan-16 -27.00 0% 0% 0.00 LEVEL 47 352.00 10-Nov-14 21-Nov-15 15-Nov-14 09-Jan-16 -9.00 0% 0% 0.00 LEVEL 48 350.00 16-Nov-14 25-Nov-15 20-Nov-14 12-Jan-16 -9.00 0% 0% 0.00 LEVEL 49 349.00 20-Nov-14 30-Nov-15 25-Nov-14 16-Jan-16 -9.00 0% 0% 0.00 LEVEL 50 348.00 25-Nov-14 06-Dec-15 30-Nov-14 19-Jan-16 -9.00 0% 0% 0.00 LEVEL 51 360.00 30-Nov-14 10-Dec-15 06-Dec-14 07-Feb-16 -22.00 0% 0% 0.00 LEVEL 52 346.00 06-Dec-14 15-Dec-15 10-Dec-14 26-Jan-16 -9.00 0% 0% 0.00 LEVEL 53 345.00 10-Dec-14 20-Dec-15 15-Dec-14 30-Jan-16 -9.00 0% 0% 0.00 LEVEL 54 344.00 15-Dec-14 24-Dec-15 20-Dec-14 02-Feb-16 -9.00 0% 0% 0.00 LEVEL 55 343.00 20-Dec-14 29-Dec-15 24-Dec-14 06-Feb-16 -9.00 0% 0% 0.00 LEVEL 56 350.00 24-Dec-14 03-Jan-16 29-Dec-14 18-Feb-16 -17.00 0% 0% 0.00 LEVEL 57 329.00 29-Dec-14 07-Jan-16 04-Jan-15 30-Jan-16 -19.00 0% 0% 0.00 LEVEL 58 332.00 03-Jan-15 14-Jan-16 07-Jan-15 06-Feb-16 -19.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Corridor/Lift Lobby Floor Screed Lift Lobby Painting - Primer & Stucco Lift Lobby False Ceiling Suspension Lift Lobby False Ceiling Tiling / Boarding Lift Lobby Painting - 1st Coat Installation of Steel Doors & Windows Lift Lobby Flooring Utility Rooms- Epoxy Flooring Staircase Plastering Staircase Painting - Primer & Stucco Staircase Handrail Fixing Staircase Painting 1st Coat Staircase Final Painting Staircase Epoxy Flooring Access from Structure Snagging & De-Snagging Embeded Conduits & Boxex - Concrete Works H/L Chilled Water Piping,Drainage,Water ,Fire fighting Piping ,Ducting, Cabling , Wiring etc Cable Trays & Cable Trunking Embeded Condiuts,Boxes and Sleeves in Walls Pressure Testing of Pipes MEP Works in Risers& Clearance Plenum Boxes,Water heaters, FCUs &fire Sprinkler drops and 2nd fixes MEP Final Fixes Sanitary ware /Toilet accessories Pre-Testing & Commissioning DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 55 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 100.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 LEVEL 59 333.00 06-Jan-15 19-Jan-16 11-Jan-15 10-Feb-16 -19.00 0% 0% 0.00 LEVEL 60 332.00 11-Jan-15 23-Jan-16 15-Jan-15 14-Feb-16 -19.00 0% 0% 0.00 LEVEL 61 348.00 14-Jan-15 26-Jan-16 19-Jan-15 07-Mar-16 -35.00 0% 0% 0.00 LEVELS 62 (MECHANICAL FLOOR) 350.00 18-Jan-15 28-Jan-16 22-Jan-15 13-Mar-16 -38.00 0% 0% 0.00 LEVELS 63-85 395.00 25-Jan-15 19-Mar-16 29-Jan-15 12-May-16 -39.00 0% 0% 0.00 LEVEL 85(MECHANICAL FLOOR) 315.00 30-Apr-15 21-Mar-16 05-May-15 15-May-16 -44.00 0% 0% 0.00 LEVEL 86 TO ROOF 324.00 06-May-15 06-Apr-16 11-May-15 31-May-16 -46.00 0% 0% 0.00 ROOFING & WATERPROOFING SYSTEM 20.00 17-May-15 08-Jun-15 21-May-15 13-Jun-15 49.00 0% 0% 0.00 SPECIALIST WORKS 120.00 11-Oct-15 23-Mar-16 10-Dec-15 27-Apr-16 -17.00 0% 0% 0.00 FACADE WORKS 582.00 19-Jul-14 19-Jan-16 15-Jul-14 A 27-Aug-16 -178.00 11.43% 1.94% 0.17 STONE CLADDING -PODIUM 135.00 09-May-15 19-Oct-15 13-May-15 24-Oct-15 82.00 0% 0% 0.00 FACADE CLADDING 359.00 23-Jul-14 12-Nov-15 15-Jul-14 A 13-Jan-16 -51.00 12.38% 2.1% 0.17 DHFCDGNT00 Curtain Wall Glazing - Level L6-10 39.00 23-Jul-14 09-Sep-14 15-Jul-14 A 30-Oct-14 -57.00 100% 20% 0.20 DHFCDGNT01 Curtain Wall Glazing - Level 11-16 45.00 11-Aug-14 02-Oct-14 13-Aug-14 A 23-Nov-14 -57.00 95.83% 15% 0.16 DHFCDGNT02 Curtain Wall Glazing - Level 17-22 45.00 04-Sep-14 30-Oct-14 09-Sep-14 A 18-Dec-14 -57.00 49.17% 5% 0.10 DHFCDGNT03 Curtain Wall Glazing - Level 23-29 45.00 29-Sep-14 24-Nov-14 22-Sep-14 A 13-Jan-15 -57.00 2.5% 2% 0.80 DHFCDGNT04 Aluminum Louvers - Level 30 12.00 15-Nov-14 29-Nov-14 05-Jan-15 18-Jan-15 -41.00 0% 0% 0.00 DHFCDGNT05 Curtain Wall Glazing - Level 30 18.00 12-Nov-14 04-Dec-14 14-Jan-15 04-Feb-15 -51.00 0% 0% 0.00 DHFCDGNT06 Curtain Wall Glazing - Level 31-36 45.00 05-Nov-14 29-Dec-14 07-Jan-15 01-Mar-15 -51.00 0% 0% 0.00 DHFCDGNT07 Curtain Wall Glazing - Level 37-42 45.00 30-Nov-14 24-Jan-15 01-Feb-15 25-Mar-15 -51.00 0% 0% 0.00 DHFCDGNT08 Curtain Wall Glazing - Level 43-48 45.00 25-Dec-14 17-Feb-15 25-Feb-15 19-Apr-15 -51.00 0% 0% 0.00 DHFCDGNT09 Curtain Wall Glazing - Level 49-54 45.00 20-Jan-15 14-Mar-15 22-Mar-15 13-May-15 -51.00 0% 0% 0.00 DHFCDGNT11 Curtain Wall Glazing - Level 55-56 14.00 04-Mar-15 21-Mar-15 04-May-15 21-May-15 -51.00 0% 0% 0.00 DHFCDGNT12 Curtain Wall Glazing - Level 57-61 45.00 18-Feb-15 12-Apr-15 20-Apr-15 13-Jun-15 -51.00 0% 0% 0.00 DHFCDGNT10 Aluminum Louvers - Level 62 12.00 02-Apr-15 16-Apr-15 03-Jun-15 17-Jun-15 -51.00 0% 0% 0.00 DHFCDGNT13 Curtain Wall Glazing - Level 62 18.00 04-Apr-15 25-Apr-15 04-Jun-15 25-Jun-15 -51.00 0% 0% 0.00 DHFCDGNT14 Curtain Wall Glazing - Level 63-68 45.00 26-Mar-15 18-May-15 26-May-15 20-Jul-15 -51.00 0% 0% 0.00 DHFCDGNT15 Curtain Wall Glazing - Level 69-74 45.00 21-Apr-15 13-Jun-15 21-Jun-15 15-Aug-15 -51.00 0% 0% 0.00 DHFCDGNT17 Curtain Wall Glazing - Level 75-80 45.00 28-May-15 21-Jul-15 29-Jul-15 20-Sep-15 -51.00 0% 0% 0.00 DHFCDGNT18 Curtain Wall Glazing - Level 81-84 30.00 01-Jul-15 06-Aug-15 01-Sep-15 08-Oct-15 -51.00 0% 0% 0.00 DHFCDGNT16 Aluminum Louvers & Cladding - Level 85 18.00 26-Jul-15 15-Aug-15 26-Sep-15 18-Oct-15 -51.00 0% 0% 0.00 DHFCDGNT19 Facade Cladding - Level 86 Above - APEX 60.00 01-Sep-15 12-Nov-15 03-Nov-15 13-Jan-16 -51.00 0% 0% 0.00 FACADE LIGHTING 381.00 20-Oct-14 19-Jan-16 31-May-15 27-Aug-16 -182.00 0% 0% 0.00 FACADE CLEANING SYSTEM 389.00 19-Jul-14 29-Oct-15 01-Oct-14 11-Jan-16 -58.00 0% 0% 0.00 CONVEYING SYSTEM 437.00 24-Aug-14 22-Feb-16 24-Aug-14 A 07-Mar-16 0.00 9.42% 20.63% 2.19 LIFT 437.00 24-Aug-14 22-Feb-16 24-Aug-14 A 07-Mar-16 0.00 9.42% 20.63% 2.19 LIFTS - (L1-L6) 437.00 24-Aug-14 22-Feb-16 24-Aug-14 A 07-Mar-16 0.00 25% 25% 1.00 DHLFTGNL00 Template & Plumbing 20.00 24-Aug-14 15-Sep-14 24-Aug-14 A 28-Sep-14 A 100% 100% 1.00 DHLFTGNL05 Control Panel Installation & Wiring 25.00 17-Sep-14 18-Oct-14 01-Oct-14 02-Nov-14 0.00 48% 0% 0.00 DHLFTGNL01 Bracket Fixing 60.00 01-Oct-14 14-Dec-14 18-Oct-14 28-Dec-14 0.00 0% 0% 0.00 DHLFTGNL02 Rail Fixing 80.00 28-Oct-14 31-Jan-15 11-Nov-14 14-Feb-15 0.00 0% 0% 0.00 DHLFTGNL04 Machine Room Equipment Installation 12.00 12-Feb-15 25-Feb-15 17-Feb-15 02-Mar-15 9.00 0% 0% 0.00 DHLFTGNL03 Entrance & Door Fixing 90.00 20-Nov-14 07-Mar-15 06-Dec-14 21-Mar-15 0.00 0% 0% 0.00 DHLFTGNL06 Counter Weight Frame Installation 7.00 04-Mar-15 11-Mar-15 18-Mar-15 25-Mar-15 0.00 0% 0% 0.00 DHLFTGNL07 Cabin Assembly 10.00 05-Mar-15 16-Mar-15 19-Mar-15 30-Mar-15 0.00 0% 0% 0.00 DHLFTGNL08 Pit Equipment Installation 4.00 17-Mar-15 21-Mar-15 31-Mar-15 04-Apr-15 0.00 0% 0% 0.00 DHLFTGNL09 Roping 6.00 22-Mar-15 28-Mar-15 05-Apr-15 11-Apr-15 0.00 0% 0% 0.00 DHLFTGNL10 Hoist way & Cabin Wiring 6.00 29-Mar-15 04-Apr-15 12-Apr-15 18-Apr-15 0.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Curtain Wall Glazing - Level L6-10 Curtain Wall Glazing - Level 11-16 Curtain Wall Glazing - Level 17-22 Curtain Wall Glazing - Level 23-29 Aluminum Louvers - Level 30 Curtain Wall Glazing - Level 30 Curtain Wall Glazing - Level 31-36 Curtain Wall Glazing - Level 37-42 Curtain Wall Glazing - Level 43-48 Curtain Wall Glazing - Level 49-54 Curtain Wall Glazing - Level 55-56 Curtain Wall Glazing - Level 57-61 Aluminum Louvers - Level 62 Curtain Wall Glazing - Level 62 Curtain Wall Glazing - Level 63-68 Curtain Wall Glazing - Level 69-74 Curtain Wall Glazing - Level 75-80 Curtain Wall Glazing - Level 81-84 Aluminum Louvers & Cladding - Level Template & Plumbing Control Panel Installation & Wiring Bracket Fixing Rail Fixing Machine Room Equipment Installation Entrance & Door Fixing Counter Weight Frame Installation Cabin Assembly Pit Equipment Installation Roping Hoist way & Cabin Wiring DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 56 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 101.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHLFTGNL11 Lift Car Works 6.00 05-Apr-15 11-Apr-15 19-Apr-15 25-Apr-15 0.00 0% 0% 0.00 DHLFTGNL12 Testing 14.00 16-Apr-15 02-May-15 30-Apr-15 17-May-15 0.00 0% 0% 0.00 DHLFTGNL22 Final finishes & Testing & Commissioing 247.00 03-May-15 22-Feb-16 18-May-15 07-Mar-16 0.00 0% 0% 0.00 LIFTS - (M7-M9) 428.00 24-Aug-14 22-Feb-16 24-Aug-14 A 25-Feb-16 -3.00 12.69% 25% 1.97 DHLFTGNM00 Template & Plumbing 65.00 24-Aug-14 10-Nov-14 24-Aug-14 A 28-Sep-14 A 50.77% 100% 1.97 DHLFTGNM05 Control Panel Installation & Wiring 18.00 11-Nov-14 01-Dec-14 01-Oct-14 23-Oct-14 32.00 0% 0% 0.00 DHLFTGNM01 Bracket Fixing 60.00 20-Nov-14 31-Jan-15 13-Oct-14 23-Dec-14 32.00 0% 0% 0.00 DHLFTGNM02 Rail Fixing 70.00 08-Dec-14 28-Feb-15 30-Oct-14 21-Jan-15 32.00 0% 0% 0.00 DHLFTGNM03 Entrance & Door Fixing 75.00 31-Dec-14 29-Mar-15 23-Nov-14 19-Feb-15 32.00 0% 0% 0.00 DHLFTGNM04 Machine Room Equipment Installation- L68 12.00 05-Mar-15 18-Mar-15 10-Mar-15 23-Mar-15 -3.00 0% 0% 0.00 DHLFTGNM06 Counter Weight Frame Installation 30.00 30-Mar-15 03-May-15 02-Apr-15 06-May-15 -3.00 0% 0% 0.00 DHLFTGNM07 Cabin Assembly 7.00 02-May-15 09-May-15 05-May-15 12-May-15 -3.00 0% 0% 0.00 DHLFTGNM08 Pit Equipment Installation 7.00 10-May-15 18-May-15 13-May-15 21-May-15 -3.00 0% 0% 0.00 DHLFTGNM09 Roping 7.00 19-May-15 26-May-15 23-May-15 30-May-15 -3.00 0% 0% 0.00 DHLFTGNM10 Hoist way & Cabin Wiring 7.00 27-May-15 03-Jun-15 31-May-15 07-Jun-15 -3.00 0% 0% 0.00 DHLFTGNM11 Lift Car Finishes 8.00 04-Jun-15 13-Jun-15 08-Jun-15 16-Jun-15 -3.00 0% 0% 0.00 DHLFTGNM12 Testing & ready for CTU 14.00 14-Jun-15 29-Jun-15 17-Jun-15 02-Jul-15 -3.00 0% 0% 0.00 DHLFTGNM22 Final finishes & Testing & Commissioing 198.00 30-Jun-15 22-Feb-16 04-Jul-15 25-Feb-16 -3.00 0% 0% 0.00 LIFTS - (H10-H11) 424.00 12-Oct-14 22-Feb-16 24-Aug-14 A 21-Feb-16 1.00 0% 25% 0.00 DHLFTGNH00 Template & Plumbing 30.00 12-Oct-14 16-Nov-14 24-Aug-14 A 28-Sep-14 A 0% 100% 0.00 DHLFTGNH05 Control Panel Installation & Wiring 24.00 17-Nov-14 15-Dec-14 01-Oct-14 01-Nov-14 37.00 0% 0% 0.00 DHLFTGNH01 Bracket Fixing 85.00 31-Dec-14 09-Apr-15 17-Nov-14 25-Feb-15 37.00 0% 0% 0.00 DHLFTGNH02 Rail Fixing 95.00 18-Jan-15 07-May-15 04-Dec-14 25-Mar-15 37.00 0% 0% 0.00 DHLFTGNH03 Entrance & Door Fixing 85.00 16-Feb-15 26-May-15 04-Jan-15 12-Apr-15 37.00 0% 0% 0.00 DHLFTGNH04 Machine Room Equipment Installation 12.00 25-May-15 07-Jun-15 24-May-15 06-Jun-15 1.00 0% 0% 0.00 DHLFTGNH06 Counter Weight Frame Installation 12.00 08-Jun-15 21-Jun-15 07-Jun-15 20-Jun-15 1.00 0% 0% 0.00 DHLFTGNH07 Cabin Assembly 8.00 20-Jun-15 28-Jun-15 18-Jun-15 27-Jun-15 1.00 0% 0% 0.00 DHLFTGNH08 Pit Equipment Installation 6.00 29-Jun-15 05-Jul-15 28-Jun-15 04-Jul-15 1.00 0% 0% 0.00 DHLFTGNH09 Roping 9.00 30-Jun-15 09-Jul-15 29-Jun-15 08-Jul-15 1.00 0% 0% 0.00 DHLFTGNH10 Hoist way & Cabin Wiring 7.00 08-Jul-15 15-Jul-15 07-Jul-15 14-Jul-15 1.00 0% 0% 0.00 DHLFTGNH11 Lift Car Finishes 7.00 16-Jul-15 26-Jul-15 15-Jul-15 25-Jul-15 1.00 0% 0% 0.00 DHLFTGNH12 Testing & ready for CTU 14.00 27-Jul-15 11-Aug-15 26-Jul-15 10-Aug-15 1.00 0% 0% 0.00 DHLFTGNH32 Final finishes & Testing & Commissioing 163.00 12-Aug-15 22-Feb-16 11-Aug-15 21-Feb-16 1.00 0% 0% 0.00 LIFTS - (H12) 413.00 18-Oct-14 22-Feb-16 24-Aug-14 A 21-Feb-16 1.00 0% 7.5% 0.00 DHLFTGNH13 Template & Plumbing 30.00 18-Oct-14 22-Nov-14 24-Aug-14 A 10-Nov-14 10.00 0% 30% 0.00 DHLFTGNH18 Control Panel Installation & Wiring 24.00 23-Nov-14 21-Dec-14 11-Nov-14 09-Dec-14 10.00 0% 0% 0.00 DHLFTGNH14 Bracket Fixing 90.00 25-Nov-14 11-Mar-15 13-Nov-14 28-Feb-15 10.00 0% 0% 0.00 DHLFTGNH15 Rail Fixing 90.00 22-Dec-14 06-Apr-15 10-Dec-14 25-Mar-15 10.00 0% 0% 0.00 DHLFTGNH16 Entrance & Door Fixing 100.00 27-Jan-15 24-May-15 15-Jan-15 11-May-15 10.00 0% 0% 0.00 DHLFTGNH17 Machine Room Equipment Installation 12.00 21-May-15 03-Jun-15 20-May-15 02-Jun-15 1.00 0% 0% 0.00 DHLFTGNH19 Counter Weight Frame Installation 12.00 04-Jun-15 17-Jun-15 03-Jun-15 16-Jun-15 1.00 0% 0% 0.00 DHLFTGNH20 Cabin Assembly 12.00 10-Jun-15 23-Jun-15 09-Jun-15 22-Jun-15 1.00 0% 0% 0.00 DHLFTGNH21 Pit Equipment Installation 7.00 24-Jun-15 01-Jul-15 23-Jun-15 30-Jun-15 1.00 0% 0% 0.00 DHLFTGNH22 Roping 11.00 25-Jun-15 07-Jul-15 24-Jun-15 06-Jul-15 1.00 0% 0% 0.00 DHLFTGNH23 Hoist way & Cabin Wiring 10.00 02-Jul-15 13-Jul-15 01-Jul-15 12-Jul-15 1.00 0% 0% 0.00 DHLFTGNH24 Lift Car Finishes 6.00 14-Jul-15 22-Jul-15 13-Jul-15 21-Jul-15 1.00 0% 0% 0.00 DHLFTGNH25 Testing & ready for CTU 14.00 23-Jul-15 08-Aug-15 22-Jul-15 06-Aug-15 1.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Lift Car Works Testing Template & Plumbing Control Panel Installation & Wiring Bracket Fixing Rail Fixing Entrance & Door Fixing Machine Room Equipment Installation- L68 Counter Weight Frame Installation Cabin Assembly Pit Equipment Installation Roping Hoist way & Cabin Wiring Lift Car Finishes Testing & ready for CTU Template & Plumbing Control Panel Installation & Wiring Bracket Fixing Rail Fixing Entrance & Door Fixing Machine Room Equipment Installation Counter Weight Frame Installation Cabin Assembly Pit Equipment Installation Roping Hoist way & Cabin Wiring Lift Car Finishes Testing & ready for CTU Template & Plumbing Control Panel Installation & Wiring Bracket Fixing Rail Fixing Entrance & Door Fixing Machine Room Equipment Installation Counter Weight Frame Installation Cabin Assembly Pit Equipment Installation Roping Hoist way & Cabin Wiring Lift Car Finishes Testing & ready for CTU DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 57 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 102.
    Activity ID ActivityName Original Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Total Float Planned % Complete Actual % Complete SPI 2014 2015 DHLFTGNH35 Final finishes & Testing & Commissioing 66.00 08-Dec-15 22-Feb-16 07-Dec-15 21-Feb-16 1.00 0% 0% 0.00 GARBAGE CHUTE 330.00 30-Aug-14 04-Oct-15 02-Sep-14 A 02-Nov-15 -23.00 3.42% 0.38% 0.11 LEVEL GF-28 110.00 30-Aug-14 11-Jan-15 02-Sep-14 A 17-Jan-15 4.00 16.05% 2% 0.12 DHGRBGNG00 Frame Fixing GF-L28 80.00 30-Aug-14 06-Dec-14 02-Sep-14 A 05-Jan-15 -8.00 33.91% 2% 0.06 DHGRBGNG01 Installation of Water Supply & FF Risers GF-L28 80.00 10-Sep-14 17-Dec-14 02-Sep-14 A 05-Jan-15 0.00 21.41% 2% 0.09 DHGRBGNG02 Electrical Conduiting & Wiring GF-L28 80.00 22-Sep-14 29-Dec-14 02-Sep-14 A 05-Jan-15 4.00 8.91% 2% 0.22 DHGRBGNG03 Chute Installation GF-L28 80.00 06-Oct-14 11-Jan-15 02-Sep-14 A 17-Jan-15 4.00 0% 2% 0.00 LEVEL 29-56 102.00 06-Dec-14 14-Apr-15 06-Jan-15 04-May-15 -8.00 0% 0% 0.00 DHGRBGN290 Frame Fixing L29-L56 80.00 06-Dec-14 10-Mar-15 06-Jan-15 08-Apr-15 -8.00 0% 0% 0.00 DHGRBGN291 Installation of Water Supply & FF Risers L29-L56 80.00 17-Dec-14 22-Mar-15 15-Jan-15 18-Apr-15 -8.00 0% 0% 0.00 DHGRBGN292 Electrical Conduiting & Wiring L29-L56 80.00 29-Dec-14 02-Apr-15 25-Jan-15 27-Apr-15 -8.00 0% 0% 0.00 DHGRBGN293 Chute Installation L29-L56 80.00 11-Jan-15 14-Apr-15 01-Feb-15 04-May-15 -8.00 0% 0% 0.00 LEVEL 57-80 92.00 10-Mar-15 06-Jul-15 09-Apr-15 28-Jul-15 -8.00 0% 0% 0.00 DHGRBGN570 Frame Fixing L57-L80 70.00 10-Mar-15 01-Jun-15 09-Apr-15 30-Jun-15 2.00 0% 0% 0.00 DHGRBGN571 Installation of Water Supply & FF Risers L57-L80 70.00 22-Mar-15 13-Jun-15 19-Apr-15 09-Jul-15 -2.00 0% 0% 0.00 DHGRBGN572 Electrical Conduiting & Wiring L57-L80 70.00 02-Apr-15 24-Jun-15 28-Apr-15 21-Jul-15 -6.00 0% 0% 0.00 DHGRBGN573 Chute Installation L57-L80 70.00 14-Apr-15 06-Jul-15 05-May-15 28-Jul-15 -8.00 0% 0% 0.00 LEVEL 81 to Roof 62.00 07-May-15 01-Aug-15 08-Jun-15 20-Aug-15 -8.00 0% 0% 0.00 DHGRBGN810 Frame Fixing L81- Roof 20.00 07-May-15 01-Jun-15 08-Jun-15 30-Jun-15 22.00 0% 0% 0.00 DHGRBGN811 Installation of Water Supply & FF Risers L81- Roof 20.00 20-May-15 13-Jun-15 17-Jun-15 09-Jul-15 18.00 0% 0% 0.00 DHGRBGN812 Electrical Conduiting & Wiring L81- Roof 20.00 01-Jun-15 24-Jun-15 27-Jun-15 21-Jul-15 14.00 0% 0% 0.00 DHGRBGN813 Chute Installation L81- Roof 20.00 06-Jul-15 01-Aug-15 29-Jul-15 20-Aug-15 -8.00 0% 0% 0.00 LEVEL GF-Roof (ALL LEVELS) 330.00 03-Sep-14 04-Oct-15 01-Oct-14 02-Nov-15 -23.00 1.54% 0% 0.00 DHGRBGN000 MEP Termination to Chute 158.00 18-Feb-15 25-Aug-15 11-Mar-15 14-Sep-15 -8.00 0% 0% 0.00 DHGRBGN001 Civil Finishes 312.00 03-Sep-14 10-Sep-15 01-Oct-14 11-Oct-15 -23.00 7.69% 0% 0.00 DHGRBGN002 Door Installation & Final Electrical Connections 250.00 25-Nov-14 17-Sep-15 24-Dec-14 19-Oct-15 -23.00 0% 0% 0.00 DHGRBGN003 Ventilation Fans 12.00 05-Sep-15 17-Sep-15 05-Oct-15 19-Oct-15 -23.00 0% 0% 0.00 DHGRBGN004 Panel Installation 12.00 19-Sep-15 04-Oct-15 20-Oct-15 02-Nov-15 -23.00 0% 0% 0.00 FINISHES AFTER DISMANTLING UTILITIES 318.00 17-May-15 13-Apr-16 21-May-15 04-Jun-16 -42.00 0% 0% 0.00 CLOSEOUT ( SNAGGING , COMMISSIONING & AS BUILTS) 427.00 22-Jul-15 14-May-16 28-Jul-15 20-Dec-16 -182.00 0% 0% 0.00 DHCHNGN210 Preparing & Submitting As built Drawings 150.00 22-Jul-15 17-Jan-16 28-Jul-15 23-Jan-16 33.00 0% 0% 0.00 DHCHNGN220 Preparing and Submitting Final O&M manuals 55.00 22-Nov-15 25-Jan-16 28-Nov-15 31-Jan-16 33.00 0% 0% 0.00 DHCHNGN230 Preparing and Submitting close out Documents 25.00 01-Mar-16 29-Mar-16 30-Jun-16 31-Jul-16 -65.00 0% 0% 0.00 DHCHNGN200 Overall Testing & Commissioning Works 120.00 17-Dec-15 05-May-16 20-Jul-16 11-Dec-16 -182.00 0% 0% 0.00 DHCHNGN300 Overall Snagging & Handing Over 90.00 30-Jan-16 14-May-16 01-Sep-16 20-Dec-16 -182.00 0% 0% 0.00 DHCHNGN500 Overall Completion 0.00 14-May-16 20-Dec-16 -182.00 0% 0% 0.00 Jul Aug Sep Oct Nov Dec Jan Feb Mar Apr May Jun Jul Aug Sep Oct Nov Dec Frame Fixing GF-L28 Installation of Water Supply & FF Risers GF-L28 Electrical Conduiting & Wiring GF-L28 Chute Installation GF-L28 Frame Fixing L29-L56 Installation of Water Supply & FF Risers L29-L56 Electrical Conduiting & Wiring L29-L56 Chute Installation L29-L56 Frame Fixing L57-L80 Installation of Water Supply & FF Risers L57-L80 Electrical Conduiting & Wiring L57-L80 Chute Installation L57-L80 Frame Fixing L81- Roof Installation of Water Supply & FF Risers L81- Roof Electrical Conduiting & Wiring L81- Roof Chute Installation L81- Roof MEP Termination to Chute Civil Finishes Door Installation & Final Electrical Ventilation Fans Panel Installation DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 58 of 58 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Project Progress Update as of 30-Sep-2014 Taregt Completion Programme - Rev 03 Date Revision Chec... Appr... 20-Aug-14 Target Completion Programme - Rev 03 (Baseline) 30-Sep-14 Schedule Update - September-14 (Update) SK
  • 103.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 2 Structure Delay
  • 104.
    Activity ID ActivityName Current Duration DAMAC Gulf Properties L.L.C Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F Total 1288.00 24-Feb-14 12-Aug-15 26-Jun-11 A 17-Aug-15 57.12% 56.34% 7.00 DAMAC HEIGHTS-Target Completion Programme- Rev 3.1 1288.00 24-Feb-14 12-Aug-15 26-Jun-11 A 17-Aug-15 57.12% 56.34% 7.00 CONSTRUCTION 1288.00 24-Feb-14 12-Aug-15 26-Jun-11 A 17-Aug-15 57.12% 56.34% 7.00 STRUCTURAL , ARCHITECTURAL , MEP 1288.00 24-Feb-14 12-Aug-15 26-Jun-11 A 17-Aug-15 57.12% 56.34% 7.00 FOUNDATION WORKS 1099.00 24-Feb-14 29-Nov-14 26-Jun-11 A 05-Jan-15 87.26% 83.62% -28.00 BASEMENT B05 (-16.00 FFL) 1099.00 24-Feb-14 29-Nov-14 26-Jun-11 A 05-Jan-15 87.26% 83.62% -28.00 STRUCTURAL B05 1099.00 24-Feb-14 29-Nov-14 26-Jun-11 A 05-Jan-15 87.26% 83.62% -28.00 ZONE A ( Area1,2 & 3) 88.00 24-Feb-14 24-Feb-14 26-Jun-11 A 06-Jun-13 A 100% 100% ZONE B (Area 4) 371.00 24-Feb-14 29-Nov-14 19-Oct-13 A 05-Jan-15 59.91% 48.45% -28.00 Soil Work - Section BB 289.00 24-Feb-14 10-Aug-14 19-Oct-13 A 16-Oct-14 100% 98.75% 21.00 DHFNAB6200 Install 1st level of Struts @+2.46 DMD (B1 Level ) 14.00 24-Feb-14 24-Feb-14 19-Oct-13 A 07-Nov-13 A 100% 100% DHFNAB6210 Excavation Works up to -4.0 DMD 8.00 24-Feb-14 24-Feb-14 19-Oct-13 A 12-Dec-13 A 100% 100% DHFNAB6230 Destress Anchores at level -4.7 DMD 2.00 05-Jul-14 06-Jul-14 30-Jan-14 A 01-Feb-14 A 100% 100% DHFNAB6220 Install 3rd level of Struts @-3.94 (B3 Level)-Sec B-B 27.00 24-Feb-14 24-Feb-14 12-Feb-14 A 12-Feb-14 A 100% 100% DHFNAB6260 Destress Anchores at level B4-6.99 DMD 2.00 07-Jul-14 08-Jul-14 01-Aug-14 A 01-Aug-14 A 100% 100% DHFNAB6240 Excavation works up to level B5-Sec B-B 25.00 09-Jul-14 09-Aug-14 12-Jul-14 A 15-Oct-14 100% 58% -18.00 DHFNAB6250 Demolition of Internal Diaphragm Wall up to B4 3.00 07-Aug-14 10-Aug-14 16-Aug-14 A 16-Oct-14 100% 94% 21.00 Soil Work - Section DD 290.00 10-Jul-14 23-Sep-14 12-Nov-13 A 01-Nov-14 100% 0% 12.00 DHFNAB6520 Excavation upto -3.79 DMD-B3 Lvl -Sec D-D 6.00 26-Jul-14 03-Aug-14 26-Jul-14 A 03-Aug-14 A 100% 100% DHFNAB6500 Install 2nd level of Struts @-0.59 DMD (B2 Level)- Sec D-D14.00 10-Jul-14 24-Jul-14 12-Nov-13 A 14-Aug-14 A 100% 100% DHFNAB6530 Strut Installation at -3.79 DMD-B3 Lvl -Sec D-D 14.00 04-Aug-14 19-Aug-14 04-Aug-14 A 19-Aug-14 A 100% 100% DHFNAB6540 Excavation upto -6.99 DMD-B4 Lvl -Sec D-D 6.00 20-Aug-14 26-Aug-14 20-Aug-14 A 26-Aug-14 A 100% 100% DHFNAB6510 Install 4th level of Struts @-6.99 (B4 Level)-Sec D-D 18.00 27-Aug-14 16-Sep-14 01-Oct-14 23-Oct-14 100% 0% -28.00 DHFNAB6270 Final Excavation Works up to B5 - Sec D-D 5.00 17-Sep-14 22-Sep-14 26-Oct-14 30-Oct-14 100% 0% -28.00 DHFNAB6280 Demolition of Remaining Internal Diaphragm Wall 3.00 21-Sep-14 23-Sep-14 29-Oct-14 01-Nov-14 100% 0% 12.00 Piles and RAFT 57.00 21-Sep-14 29-Nov-14 29-Oct-14 05-Jan-15 12.16% 0% -28.00 DHFNAB6290 Pile Integrity Test By Zetas 4.00 21-Sep-14 24-Sep-14 29-Oct-14 02-Nov-14 100% 0% -28.00 DHFNAB6300 Pile Head Trimming 6.00 25-Sep-14 01-Oct-14 03-Nov-14 09-Nov-14 83.33% 0% -28.00 DHFNAB6310 Dressing /Surface Preparation 4.00 02-Oct-14 08-Oct-14 10-Nov-14 13-Nov-14 0% 0% -28.00 DHFNAB6320 Anti termite/ Blinding & Pile Profiling 4.00 09-Oct-14 13-Oct-14 15-Nov-14 18-Nov-14 0% 0% -28.00 DHFNAB6350Waterproofing Works and Protection Screed 3.00 14-Oct-14 16-Oct-14 19-Nov-14 22-Nov-14 0% 0% -21.00 DHFNAB6330 Pile Head treatment 4.00 14-Oct-14 18-Oct-14 19-Nov-14 23-Nov-14 0% 0% -28.00 DHFNAB6340 Therma-cool Insulation Boards 4.00 14-Oct-14 18-Oct-14 19-Nov-14 23-Nov-14 0% 0% -28.00 DHFNAB6360 Vertical Protection Boards 6.00 19-Oct-14 26-Oct-14 24-Nov-14 30-Nov-14 0% 0% -28.00 DHFNAB6390Reinforcement Works of Tower crane Foundation inside Raft5.00 30-Oct-14 04-Nov-14 06-Dec-14 10-Dec-14 0% 0% -20.00 DHFNAB6370Rebar for Raft 15.00 27-Oct-14 12-Nov-14 01-Dec-14 18-Dec-14 0% 0% -28.00 DHFNAB6380MEP Works (Raft) 15.00 28-Oct-14 13-Nov-14 03-Dec-14 20-Dec-14 0% 0% -28.00 DHFNAB6400 Concrete Pour 1.00 15-Nov-14 15-Nov-14 21-Dec-14 21-Dec-14 0% 0% -28.00 DHCLBB3100Columns & Walls 6.00 16-Nov-14 22-Nov-14 22-Dec-14 28-Dec-14 0% 0% -27.00 DHRWBB310R0etaining Wall 12.00 16-Nov-14 29-Nov-14 22-Dec-14 05-Jan-15 0% 0% -28.00 STAIRCASES BASEMENT B05 99.00 24-Feb-14 16-Mar-14 05-Dec-13 A 22-Dec-13 A 0% 0% DHSLAP5130 Stair # 3 8.00 24-Feb-14 24-Feb-14 05-Dec-13 A 10-Dec-13 A 100% 100% DHSLAP5135 Stair # 1 4.00 16-Mar-14 16-Mar-14 08-Dec-13 A 13-Dec-13 A 100% 100% DHSLAP5125 Stair # 2 5.00 16-Mar-14 16-Mar-14 17-Dec-13 A 22-Dec-13 A 100% 100% BASEMENT & PODIUM 1169.00 24-Feb-14 04-Jun-15 31-May-13 A 09-Jul-15 81.24% 81.24% -28.00 BASEMENT B04 (-12.80 FFL) 1034.00 24-Feb-14 27-Dec-14 31-May-13 A 01-Feb-15 77.49% 77.49% -28.00 STRUCTURAL B04 1034.00 24-Feb-14 27-Dec-14 31-May-13 A 01-Feb-15 77.49% 77.49% -28.00 BASEMENT B04 (ZONE A) 36.00 24-Feb-14 24-Feb-14 31-May-13 A 11-Aug-13 A 100% 100% 2014 2015 2016 2017 Install 1st level of Struts @+2.46 DMD (B1 Level ) Excavation Works up to -4.0 DMD Destress Anchores at level -4.7 DMD Install 3rd level of Struts @-3.94 (B3 Level)-Sec B-B Destress Anchores at level B4-6.99 DMD Excavation works up to level B5-Sec B-B Demolition of Internal Diaphragm Wall up to B4 Excavation upto -3.79 DMD-B3 Lvl -Sec D-D Install 2nd level of Struts @-0.59 DMD (B2 Level)- Sec D-D Strut Installation at -3.79 DMD-B3 Lvl -Sec D-D Excavation upto -6.99 DMD-B4 Lvl -Sec D-D Install 4th level of Struts @-6.99 (B4 Level)-Sec D-D Final Excavation Works up to B5 - Sec D-D Demolition of Remaining Internal Diaphragm Wall Pile Integrity Test By Zetas Pile Head Trimming Dressing /Surface Preparation Anti termite/ Blinding & Pile Profiling Waterproofing Works and Protection Screed Pile Head treatment Therma-cool Insulation Boards Vertical Protection Boards Reinforcement Works of Tower crane Foundation inside Raft Rebar for Raft MEP Works (Raft) Concrete Pour Columns & Walls Retaining Wall Stair # 1 Stair # 2 DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 1 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 105.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F BASEMENT B04 (ZONE B) 28.00 24-Nov-14 27-Dec-14 30-Dec-14 01-Feb-15 0% 0% -28.00 DHCLBB3110Removal Of Struts-B4 6.00 26-Nov-14 03-Dec-14 03-Jan-15 08-Jan-15 0% 0% -28.00 DHSLBB3100Construct Slab - Level B04 14.00 24-Nov-14 10-Dec-14 30-Dec-14 15-Jan-15 0% 0% -28.00 DHCLBB2100Columns & Walls 6.00 11-Dec-14 17-Dec-14 17-Jan-15 22-Jan-15 0% 0% -28.00 DHRWBB2100Retaining Wall 14.00 11-Dec-14 27-Dec-14 17-Jan-15 01-Feb-15 0% 0% -28.00 STAIRCASES BASEMENT B04 100.00 24-Feb-14 25-Mar-14 13-Dec-13 A 03-Feb-14 A 0% 0% DHSLAP5205 Stair # 1 4.00 25-Mar-14 25-Mar-14 13-Dec-13 A 18-Dec-13 A 100% 100% DHSLAP5270 Stair # 3 8.00 24-Feb-14 24-Feb-14 13-Dec-13 A 18-Dec-13 A 100% 100% DHSLAP5215 Stair # 2 5.00 25-Mar-14 25-Mar-14 29-Jan-14 A 03-Feb-14 A 100% 100% BASEMENT B03 (-9.60 FFL) 1046.00 24-Feb-14 15-Jan-15 19-Jun-13 A 19-Feb-15 77.49% 77.49% -28.00 STRUCTURAL B03 1046.00 24-Feb-14 15-Jan-15 19-Jun-13 A 19-Feb-15 77.49% 77.49% -28.00 BASEMENT B03 (ZONE A) 51.00 24-Feb-14 24-Feb-14 19-Jun-13 A 10-Sep-13 A 100% 100% BASEMENT B03 (ZONE B) 24.00 18-Dec-14 15-Jan-15 24-Jan-15 19-Feb-15 0% 0% -28.00 DHSLBB2110Removal Of Struts-B3 6.00 21-Dec-14 27-Dec-14 26-Jan-15 01-Feb-15 0% 0% -28.00 DHSLBB2100Slab - Level B03 14.00 18-Dec-14 04-Jan-15 24-Jan-15 08-Feb-15 0% 0% -28.00 DHCLBB1100Columns & Walls 7.00 05-Jan-15 12-Jan-15 09-Feb-15 16-Feb-15 0% 0% -26.00 DHRWBB1100Retaining Wall 10.00 05-Jan-15 15-Jan-15 09-Feb-15 19-Feb-15 0% 0% -28.00 STAIRCASES BASEMENT B03 8.00 01-Apr-14 01-Apr-14 19-Dec-13 A 23-Feb-14 A 0% 0% DHSLAP5145 Stair # 3 8.00 01-Apr-14 01-Apr-14 19-Dec-13 A 24-Dec-13 A 100% 100% DHSLAP5150 Stair # 1 4.00 01-Apr-14 01-Apr-14 02-Feb-14 A 07-Feb-14 A 100% 100% DHSLAP5140 Stair # 2 5.00 01-Apr-14 01-Apr-14 18-Feb-14 A 23-Feb-14 A 100% 100% BASEMENT B02 (-6.40 FFL) 1060.00 24-Feb-14 07-Feb-15 30-Jun-13 A 14-Mar-15 77.49% 77.49% -23.00 STRUCTURAL B02 1060.00 24-Feb-14 07-Feb-15 30-Jun-13 A 14-Mar-15 77.49% 77.49% -23.00 BASEMENT B02 (ZONE A) 67.00 24-Feb-14 24-Feb-14 30-Jun-13 A 24-Sep-13 A 100% 100% BASEMENT B02 (ZONE B) 25.00 10-Jan-15 07-Feb-15 14-Feb-15 14-Mar-15 0% 0% -23.00 DHCLBGF110Removal Of Struts-B2 6.00 10-Jan-15 15-Jan-15 14-Feb-15 19-Feb-15 0% 0% -25.00 DHSLBB1100Slab - Level B02 10.00 15-Jan-15 26-Jan-15 19-Feb-15 02-Mar-15 0% 0% -28.00 DHCLBGF100Columns & Walls 6.00 28-Jan-15 03-Feb-15 04-Mar-15 10-Mar-15 0% 0% -28.00 DHRWBGF100 Retaining Wall 10.00 27-Jan-15 07-Feb-15 03-Mar-15 14-Mar-15 0% 0% -23.00 STAIRCASES BASEMENT B02 10.00 08-Apr-14 08-Apr-14 24-Dec-13 A 23-Feb-14 A 0% 0% DHSLAP5156 Stair # 3 8.00 08-Apr-14 08-Apr-14 24-Dec-13 A 29-Dec-13 A 100% 100% DHSLAP5155 Stair # 2 5.00 08-Apr-14 08-Apr-14 12-Feb-14 A 17-Feb-14 A 100% 100% DHSLAP5157 Stair # 1 4.00 08-Apr-14 08-Apr-14 18-Feb-14 A 23-Feb-14 A 100% 100% BASEMENT B01 (-3.20 FFL) 1069.00 24-Feb-14 03-Mar-15 16-Jul-13 A 07-Apr-15 78.22% 78.22% -28.00 STRUCTURAL B01 1069.00 24-Feb-14 03-Mar-15 16-Jul-13 A 07-Apr-15 78.22% 78.22% -28.00 BASEMENT B01 (ZONE A) 619.00 24-Feb-14 24-Feb-14 16-Jul-13 A 22-Oct-13 A 100% 100% BASEMENT B01 (ZONE B) 27.00 01-Feb-15 03-Mar-15 08-Mar-15 07-Apr-15 0% 0% -28.00 DHCLBP1110Removal Of Struts-B1 6.00 01-Feb-15 07-Feb-15 08-Mar-15 14-Mar-15 0% 0% -23.00 DHSLBGF100Slab - Level B01 14.00 04-Feb-15 19-Feb-15 11-Mar-15 26-Mar-15 0% 0% -28.00 DHCLBP1100Columns & Walls 10.00 21-Feb-15 03-Mar-15 28-Mar-15 07-Apr-15 0% 0% -28.00 STAIRCASES BASEMENT B01 12.00 12-Apr-14 15-Apr-14 01-Jan-14 A 15-Apr-14 A 0% 0% DHSLAP5165 Stair # 3 8.00 15-Apr-14 15-Apr-14 01-Jan-14 A 06-Jan-14 A 100% 100% DHSLAP5160 Stair # 2 5.00 15-Apr-14 15-Apr-14 14-Feb-14 A 19-Feb-14 A 100% 100% DHSLAP5167 Stair # 1 4.00 12-Apr-14 15-Apr-14 12-Apr-14 A 15-Apr-14 A 100% 100% GROUND FLOOR (000 FFL) 1067.00 24-Feb-14 23-Mar-15 22-Aug-13 A 27-Apr-15 78.69% 78.69% -28.00 STRUCTURAL GF 1067.00 24-Feb-14 23-Mar-15 22-Aug-13 A 27-Apr-15 78.69% 78.69% -28.00 GROUND FLOOR (ZONE A) 634.00 24-Feb-14 24-Feb-14 22-Aug-13 A 04-Nov-13 A 100% 100% GROUND FLOOR (ZONE B) 17.00 04-Mar-15 23-Mar-15 08-Apr-15 27-Apr-15 0% 0% -28.00 DHSLBP1100Slab - Level GF 12.00 04-Mar-15 17-Mar-15 08-Apr-15 21-Apr-15 0% 0% -28.00 2014 2015 2016 2017 Removal Of Struts-B4 Construct Slab - Level B04 Columns & Walls Retaining Wall Stair # 1 Stair # 2 Removal Of Struts-B3 Slab - Level B03 Columns & Walls Retaining Wall Stair # 3 Stair # 1 Stair # 2 Removal Of Struts-B2 Slab - Level B02 Columns & Walls Retaining Wall Stair # 3 Stair # 2 Stair # 1 Removal Of Struts-B1 Slab - Level B01 Columns & Walls Stair # 3 Stair # 2 Stair # 1 Slab - Level GF DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 2 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 106.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F DHCLBP2100Columns & Walls 5.00 18-Mar-15 23-Mar-15 22-Apr-15 27-Apr-15 0% 0% -28.00 STAIRCASES GROUND FLOOR 14.00 19-Apr-14 22-Apr-14 08-Jan-14 A 22-Apr-14 A 0% 0% DHSLAP5175 Stair # 3 8.00 22-Apr-14 22-Apr-14 08-Jan-14 A 13-Jan-14 A 100% 100% DHSLAP5170 Stair # 2 5.00 22-Apr-14 22-Apr-14 14-Feb-14 A 19-Feb-14 A 100% 100% DHSLAP5180 Stair # 1 4.00 19-Apr-14 22-Apr-14 19-Apr-14 A 22-Apr-14 A 100% 100% LEVEL P1 (+3.10 FFL) 1057.00 24-Feb-14 06-Apr-15 22-Aug-13 A 11-May-15 84.72% 84.72% -28.00 STRUCTURAL P1 1057.00 24-Feb-14 06-Apr-15 22-Aug-13 A 11-May-15 84.72% 84.72% -28.00 LEVEL P1 (ZONE A) 664.00 24-Feb-14 24-Feb-14 22-Aug-13 A 24-Nov-13 A 100% 100% LEVEL P1 (ZONE B) 12.00 24-Mar-15 06-Apr-15 28-Apr-15 11-May-15 0% 0% -28.00 DHSLBP2100Slab - Level P1 7.00 24-Mar-15 31-Mar-15 28-Apr-15 05-May-15 0% 0% -28.00 DHCLBP3100Columns & Walls 5.00 01-Apr-15 06-Apr-15 06-May-15 11-May-15 0% 0% -28.00 STAIRCASES LEVEL P1 15.00 24-Apr-14 29-Apr-14 31-Jan-14 A 29-Apr-14 A 0% 0% DHSLAP5190 Stair # 3 6.00 24-Apr-14 24-Apr-14 31-Jan-14 A 05-Feb-14 A 100% 100% DHSLAP5195 Stair # 1 4.00 26-Apr-14 29-Apr-14 26-Apr-14 A 29-Apr-14 A 100% 100% DHSLAP5185 Stair # 2 5.00 24-Apr-14 29-Apr-14 24-Apr-14 A 29-Apr-14 A 100% 100% LEVEL P2 (+6.20 FFL) 470.00 24-Feb-14 20-Apr-15 20-Oct-13 A 26-May-15 84.73% 84.73% -28.00 STRUCTURAL P2 470.00 24-Feb-14 20-Apr-15 20-Oct-13 A 26-May-15 84.73% 84.73% -28.00 LEVEL P2 (ZONE A) 72.00 24-Feb-14 24-Feb-14 20-Oct-13 A 13-Dec-13 A 100% 100% LEVEL P2 (ZONE B) 12.00 07-Apr-15 20-Apr-15 12-May-15 26-May-15 0% 0% -28.00 DHSLBP3100Slab - Level P2 7.00 07-Apr-15 14-Apr-15 12-May-15 20-May-15 0% 0% -28.00 DHCLBP4100Columns & Walls 5.00 15-Apr-15 20-Apr-15 21-May-15 26-May-15 0% 0% -28.00 STAIRCASES LEVEL P2 16.00 30-Apr-14 05-May-14 12-Feb-14 A 05-May-14 A 0% 0% DHSLAP5210 Stair # 3 6.00 30-Apr-14 30-Apr-14 12-Feb-14 A 17-Feb-14 A 100% 100% DHSLAP5220 Stair # 1 4.00 01-May-14 05-May-14 01-May-14 A 05-May-14 A 100% 100% DHSLAP5200 Stair # 2 5.00 30-Apr-14 05-May-14 30-Apr-14 A 05-May-14 A 100% 100% LEVEL P3 (+9.30 FFL) 472.00 24-Feb-14 04-May-15 04-Nov-13 A 09-Jun-15 84.81% 84.81% -28.00 STRUCTURAL P3 472.00 24-Feb-14 04-May-15 04-Nov-13 A 09-Jun-15 84.81% 84.81% -28.00 LEVEL P3 (ZONE A) 32.00 24-Feb-14 24-Feb-14 04-Nov-13 A 31-Dec-13 A 100% 100% LEVEL P3 (ZONE B) 12.00 21-Apr-15 04-May-15 27-May-15 09-Jun-15 0% 0% -28.00 DHSLBP4100Slab - Level P3 7.00 21-Apr-15 28-Apr-15 27-May-15 03-Jun-15 0% 0% -28.00 DHCLBP5100Columns & Walls 5.00 29-Apr-15 04-May-15 04-Jun-15 09-Jun-15 0% 0% -28.00 STAIRCASES LEVEL P3 6.00 06-May-14 12-May-14 06-May-14 A 12-May-14 A 0% 0% DHSLAP5250 Stair # 1 4.00 07-May-14 11-May-14 07-May-14 A 11-May-14 A 100% 100% DHSLAP5230 Stair # 2 5.00 06-May-14 11-May-14 06-May-14 A 11-May-14 A 100% 100% DHSLAP5240 Stair # 3 6.00 06-May-14 12-May-14 06-May-14 A 12-May-14 A 100% 100% LEVEL P4 (+12.4 FFL) 471.00 24-Feb-14 19-May-15 05-Dec-13 A 23-Jun-15 84.73% 84.73% -28.00 STRUCTURAL P4 471.00 24-Feb-14 19-May-15 05-Dec-13 A 23-Jun-15 84.73% 84.73% -28.00 LEVEL P4 (ZONE A) 34.00 24-Feb-14 24-Feb-14 05-Dec-13 A 21-Jan-14 A 100% 100% LEVEL P4 (ZONE B) 12.00 05-May-15 19-May-15 10-Jun-15 23-Jun-15 0% 0% -28.00 DHSLBP5100Slab - Level P4 7.00 05-May-15 12-May-15 10-Jun-15 17-Jun-15 0% 0% -28.00 DHCLBP5110Columns & Walls 5.00 13-May-15 19-May-15 18-Jun-15 23-Jun-15 0% 0% -28.00 STAIRCASES LEVEL P4 7.00 12-May-14 19-May-14 12-May-14 A 19-May-14 A 0% 0% DHSLAP5267 Stair # 1 4.00 13-May-14 17-May-14 13-May-14 A 17-May-14 A 100% 100% DHSLAP5260 Stair # 2 5.00 12-May-14 17-May-14 12-May-14 A 17-May-14 A 100% 100% DHSLAP5265 Stair # 3 6.00 13-May-14 19-May-14 13-May-14 A 19-May-14 A 100% 100% LEVEL P5 (+15.79 FFL) 458.00 24-Feb-14 04-Jun-15 08-Jan-14 A 09-Jul-15 92.33% 92.33% -28.00 STRUCTURAL P5 458.00 24-Feb-14 04-Jun-15 08-Jan-14 A 09-Jul-15 92.33% 92.33% -28.00 LEVEL P5 (ZONE A) 35.00 24-Feb-14 25-Mar-14 08-Jan-14 A 24-Feb-14 A 100% 100% LEVEL P5 (ZONE B) 14.00 20-May-15 04-Jun-15 24-Jun-15 09-Jul-15 0% 0% -28.00 2014 2015 2016 2017 Columns & Walls Stair # 3 Stair # 2 Stair # 1 Slab - Level P1 Columns & Walls Stair # 3 Stair # 1 Stair # 2 Slab - Level P2 Columns & Walls Stair # 3 Stair # 1 Stair # 2 Slab - Level P3 Columns & Walls Stair # 1 Stair # 2 Stair # 3 Slab - Level P4 Columns & Walls Stair # 1 Stair # 2 Stair # 3 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 3 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 107.
    Activity ID ActivityName Current Duration DAMAC Gulf Properties L.L.C Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float DHSLBP5130Slab - Level P5 14.00 20-May-15 04-Jun-15 24-Jun-15 09-Jul-15 0% 0% -28.00 STAIRCASES LEVEL P5 6.00 18-May-14 24-May-14 18-May-14 A 24-May-14 A 0% 0% DHSLAP5290 Stair # 2 5.00 18-May-14 22-May-14 18-May-14 A 22-May-14 A 100% 100% DHSLAP5299 Stair # 1 4.00 20-May-14 24-May-14 20-May-14 A 24-May-14 A 100% 100% TOWER 454.00 24-Feb-14 12-Aug-15 10-Feb-14 A 17-Aug-15 45.41% 44.61% 7.00 LEVELS 06 - 29 207.00 24-Feb-14 23-Oct-14 10-Feb-14 A 27-Oct-14 100% 100% 50.00 LEVEL 06 83.00 24-Feb-14 29-May-14 10-Feb-14 A 18-May-14 A 100% 100% STRUCTURAL - LEVEL 6 20.00 24-Feb-14 16-Mar-14 10-Feb-14 A 09-Mar-14 A 100% 100% DHCWA07100Core Wal - Level 06 6.00 24-Feb-14 24-Feb-14 15-Feb-14 A 20-Feb-14 A 100% 100% DHSLA06100Construction of Horizontals - L06 4.00 10-Mar-14 11-Mar-14 10-Feb-14 A 04-Mar-14 A 100% 100% DHCWA07110Construction of Verticals - L06 3.00 13-Mar-14 16-Mar-14 06-Mar-14 A 09-Mar-14 A 100% 100% STAIRCASES 4.00 25-May-14 29-May-14 08-May-14 A 18-May-14 A 0% 0% DHSLA06102Stair # 2 4.00 25-May-14 29-May-14 08-May-14 A 13-May-14 A 100% 100% DHSLA06104Stair # 1 4.00 25-May-14 29-May-14 13-May-14 A 18-May-14 A 100% 100% LEVEL 07 83.00 24-Feb-14 05-Jun-14 20-Feb-14 A 24-May-14 A 100% 100% STRUCTURAL - LEVEL 07 21.00 24-Feb-14 24-Mar-14 20-Feb-14 A 20-Mar-14 A 100% 100% DHCWA08100Core Wal - Level 07 9.00 24-Feb-14 05-Mar-14 20-Feb-14 A 28-Feb-14 A 100% 100% DHSLA07100Construction of Horizontals - L07 4.00 17-Mar-14 20-Mar-14 06-Mar-14 A 16-Mar-14 A 100% 100% DHCWA08110Construction of Verticals - L07 3.00 22-Mar-14 24-Mar-14 16-Mar-14 A 20-Mar-14 A 100% 100% STAIRCASES 4.00 02-Jun-14 05-Jun-14 17-May-14 A 24-May-14 A 0% 0% A1330 Stair # 2 4.00 02-Jun-14 05-Jun-14 17-May-14 A 22-May-14 A 100% 100% A1320 Stair # 1 4.00 02-Jun-14 05-Jun-14 18-May-14 A 24-May-14 A 100% 100% LEVEL 08 83.00 06-Mar-14 11-Jun-14 01-Mar-14 A 31-May-14 A 100% 100% STRUCTURAL WORKS - LEVEL 08 22.00 06-Mar-14 31-Mar-14 01-Mar-14 A 28-Mar-14 A 100% 100% DHCWA09100Core Wal - Level 08 9.00 06-Mar-14 16-Mar-14 01-Mar-14 A 11-Mar-14 A 100% 100% DHSLA08100Construction of Horizontals - L08 4.00 24-Mar-14 27-Mar-14 16-Mar-14 A 24-Mar-14 A 100% 100% DHCWA09110Construction of Verticals - L08 3.00 29-Mar-14 31-Mar-14 25-Mar-14 A 28-Mar-14 A 100% 100% STAIRCASES 4.00 08-Jun-14 11-Jun-14 22-May-14 A 31-May-14 A 0% 0% A1350 Stair # 2 4.00 08-Jun-14 11-Jun-14 22-May-14 A 28-May-14 A 100% 100% A1340 Stair # 1 4.00 08-Jun-14 11-Jun-14 25-May-14 A 31-May-14 A 100% 100% LEVEL 09 79.00 17-Mar-14 17-Jun-14 12-Mar-14 A 23-Jun-14 A 100% 100% STRUCTURAL WORKS -LEVEL 09 19.00 17-Mar-14 07-Apr-14 12-Mar-14 A 08-Apr-14 A 100% 100% DHCWA10100Core Wall - Level 09 10.00 17-Mar-14 27-Mar-14 12-Mar-14 A 27-Mar-14 A 100% 100% DHSLA09100Construction of Horizontals - L09 4.00 31-Mar-14 03-Apr-14 25-Mar-14 A 03-Apr-14 A 100% 100% DHCWA10110Construction of Verticals - L09 3.00 05-Apr-14 07-Apr-14 03-Apr-14 A 08-Apr-14 A 100% 100% STAIRCASES 4.00 14-Jun-14 17-Jun-14 19-Jun-14 A 23-Jun-14 A 0% 0% A1360 Stair # 1 4.00 14-Jun-14 17-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% A1370 Stair # 2 4.00 14-Jun-14 17-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% LEVEL 10 74.00 29-Mar-14 23-Jun-14 29-Mar-14 A 23-Jun-14 A 100% 100% STRUCTURAL WORKS -LEVEL 10 15.00 29-Mar-14 14-Apr-14 29-Mar-14 A 15-Apr-14 A 100% 100% DHCWA11100Core Wall - Level 10 4.00 29-Mar-14 01-Apr-14 29-Mar-14 A 06-Apr-14 A 100% 100% DHSLA10100Construction of Horizontals - L10 4.00 07-Apr-14 10-Apr-14 05-Apr-14 A 10-Apr-14 A 100% 100% DHCWA11110Construction of Verticals - L10 3.00 12-Apr-14 14-Apr-14 13-Apr-14 A 15-Apr-14 A 100% 100% STAIRCASES 4.00 19-Jun-14 23-Jun-14 19-Jun-14 A 23-Jun-14 A 0% 0% A1380 Stair # 1 4.00 19-Jun-14 23-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% A1390 Stair # 2 4.00 19-Jun-14 23-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% LEVEL 11 75.00 02-Apr-14 29-Jun-14 07-Apr-14 A 23-Jun-14 A 100% 100% STRUCTURAL WORKS -LEVEL 11 16.00 02-Apr-14 20-Apr-14 07-Apr-14 A 21-Apr-14 A 100% 100% DHCWA12100Core Wall - Level 11 4.00 02-Apr-14 06-Apr-14 07-Apr-14 A 08-Apr-14 A 100% 100% 2014 2015 2016 2017 M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F Slab - Level P5 Stair # 2 Stair # 1 Core Wal - Level 06 Construction of Horizontals - L06 Construction of Verticals - L06 Stair # 2 Stair # 1 Core Wal - Level 07 Construction of Horizontals - L07 Construction of Verticals - L07 Stair # 2 Stair # 1 Core Wal - Level 08 Construction of Horizontals - L08 Construction of Verticals - L08 Stair # 2 Stair # 1 Core Wall - Level 09 Construction of Horizontals - L09 Construction of Verticals - L09 Stair # 1 Stair # 2 Core Wall - Level 10 Construction of Horizontals - L10 Construction of Verticals - L10 Stair # 1 Stair # 2 Core Wall - Level 11 DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 4 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 108.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float DHSLA11100Construction of Horizontals - L11 4.00 14-Apr-14 17-Apr-14 12-Apr-14 A 17-Apr-14 A 100% 100% DHCWA12110Construction of Verticals - L11 2.00 19-Apr-14 20-Apr-14 18-Apr-14 A 21-Apr-14 A 100% 100% STAIRCASES 4.00 25-Jun-14 29-Jun-14 19-Jun-14 A 23-Jun-14 A 0% 0% A1400 Stair # 1 4.00 25-Jun-14 29-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% A1410 Stair # 2 4.00 25-Jun-14 29-Jun-14 19-Jun-14 A 23-Jun-14 A 100% 100% LEVEL 12 144.00 07-Apr-14 07-Jul-14 06-Apr-14 A 23-Jun-14 A 100% 100% STRUCTURAL WORKS -LEVEL 12 144.00 07-Apr-14 27-Apr-14 06-Apr-14 A 28-Apr-14 A 100% 100% DHCWA13120Tower Crane Jump 1.00 13-Apr-14 13-Apr-14 06-Apr-14 A 06-Apr-14 A 100% 100% DHCWA13100Core Wall - Level 12 6.00 07-Apr-14 13-Apr-14 10-Apr-14 A 14-Apr-14 A 100% 100% DHSLA12100Construction of Horizontals - L12 4.00 21-Apr-14 24-Apr-14 19-Apr-14 A 24-Apr-14 A 100% 100% DHCWA13110Construction of Verticals - L12 2.00 26-Apr-14 27-Apr-14 25-Apr-14 A 28-Apr-14 A 100% 100% STAIRCASES 4.00 03-Jul-14 07-Jul-14 19-Jun-14 A 23-Jun-14 A 0% 0% A1420 Stair # 1 4.00 03-Jul-14 07-Jul-14 19-Jun-14 A 23-Jun-14 A 100% 100% A1430 Stair # 2 3.00 05-Jul-14 07-Jul-14 19-Jun-14 A 23-Jun-14 A 100% 100% LEVEL 13 79.00 14-Apr-14 15-Jul-14 15-Apr-14 A 14-Jul-14 A 100% 100% STRUCTURAL WORKS -LEVEL 13 17.00 14-Apr-14 03-May-14 15-Apr-14 A 05-May-14 A 100% 100% DHCWA14100Core Wall - Level 13 4.00 14-Apr-14 17-Apr-14 15-Apr-14 A 20-Apr-14 A 100% 100% DHSLA13100Construction of Horizontals - L13 3.00 28-Apr-14 30-Apr-14 25-Apr-14 A 01-May-14 A 100% 100% DHCWA14110Construction of Verticals - L13 2.00 01-May-14 03-May-14 02-May-14 A 05-May-14 A 100% 100% STAIRCASES 4.00 12-Jul-14 15-Jul-14 19-Jun-14 A 14-Jul-14 A 0% 0% A1450 Stair # 2 3.00 13-Jul-14 15-Jul-14 19-Jun-14 A 23-Jun-14 A 100% 100% A1440 Stair # 1 4.00 12-Jul-14 15-Jul-14 23-Jun-14 A 14-Jul-14 A 100% 100% LEVEL 14 82.00 19-Apr-14 23-Jul-14 21-Apr-14 A 20-Jul-14 A 100% 100% STRUCTURAL WORKS - LEVEL 14 18.00 19-Apr-14 08-May-14 21-Apr-14 A 11-May-14 A 100% 100% DHCWA15100Core Wall - Level 14 4.00 19-Apr-14 22-Apr-14 21-Apr-14 A 27-Apr-14 A 100% 100% DHSLA14100Construction of Horizontals - L14 3.00 04-May-14 06-May-14 03-May-14 A 08-May-14 A 100% 100% DHCWA15110Construction of Verticals - L14 2.00 07-May-14 08-May-14 09-May-14 A 11-May-14 A 100% 100% STAIRCASES 4.00 20-Jul-14 23-Jul-14 16-Jul-14 A 20-Jul-14 A 0% 0% A1460 Stair # 1 4.00 20-Jul-14 23-Jul-14 16-Jul-14 A 20-Jul-14 A 100% 100% A1470 Stair # 2 3.00 21-Jul-14 23-Jul-14 17-Jul-14 A 20-Jul-14 A 100% 100% LEVEL 15 84.00 23-Apr-14 02-Aug-14 28-Apr-14 A 26-Jul-14 A 100% 100% STRUCTURAL WORKS -LEVEL 15 19.00 23-Apr-14 14-May-14 28-Apr-14 A 18-May-14 A 100% 100% DHCWA16100Core Wall - Level 15 9.00 23-Apr-14 03-May-14 28-Apr-14 A 05-May-14 A 100% 100% DHSLA15100Construction of Horizontals - L15 3.00 10-May-14 12-May-14 10-May-14 A 15-May-14 A 100% 100% DHCWA16110Construction of Verticals - L15 2.00 13-May-14 14-May-14 17-May-14 A 18-May-14 A 100% 100% STAIRCASES 4.00 27-Jul-14 02-Aug-14 22-Jul-14 A 26-Jul-14 A 0% 0% A1480 Stair # 1 4.00 27-Jul-14 02-Aug-14 22-Jul-14 A 26-Jul-14 A 100% 100% A1490 Stair # 2 3.00 30-Jul-14 02-Aug-14 22-Jul-14 A 26-Jul-14 A 100% 100% LEVEL 16 121.00 04-May-14 07-Aug-14 05-May-14 A 31-Jul-14 A 100% 100% STRUCTURAL WORKS -LEVEL 16 121.00 04-May-14 20-May-14 05-May-14 A 23-May-14 A 100% 100% DHCWA17120Tower Crane Jump 1.00 08-May-14 08-May-14 05-May-14 A 05-May-14 A 100% 100% DHCWA17100Core Wall - Level 16 5.00 04-May-14 08-May-14 06-May-14 A 08-May-14 A 100% 100% DHSLA16100Construction of Horizontals- L16 3.00 15-May-14 18-May-14 16-May-14 A 20-May-14 A 100% 100% DHCWA17110Construction of Verticals - L16 2.00 19-May-14 20-May-14 21-May-14 A 23-May-14 A 100% 100% STAIRCASES 4.00 04-Aug-14 07-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0% A1500 Stair # 1 4.00 04-Aug-14 07-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% A1510 Stair # 2 3.00 05-Aug-14 07-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% LEVEL 17 80.00 10-May-14 13-Aug-14 10-May-14 A 31-Jul-14 A 100% 100% STRUCTURAL WORKS - LEVEL 17 15.00 10-May-14 26-May-14 10-May-14 A 30-May-14 A 100% 100% 2014 2015 2016 2017 M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F Construction of Horizontals - L11 Construction of Verticals - L11 Stair # 1 Stair # 2 Tower Crane Jump Core Wall - Level 12 Construction of Horizontals - L12 Construction of Verticals - L12 Stair # 1 Stair # 2 Core Wall - Level 13 Construction of Horizontals - L13 Construction of Verticals - L13 Stair # 2 Stair # 1 Core Wall - Level 14 Construction of Horizontals - L14 Construction of Verticals - L14 Stair # 1 Stair # 2 Core Wall - Level 15 Construction of Horizontals - L15 Construction of Verticals - L15 Stair # 1 Stair # 2 Tower Crane Jump Core Wall - Level 16 Construction of Horizontals- L16 Construction of Verticals - L16 Stair # 1 Stair # 2 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 5 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 109.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float DHCWA18100Core Wall - Level 17 5.00 10-May-14 14-May-14 10-May-14 A 14-May-14 A 100% 100% DHSLA17100Construction of Horizontals - L17 3.00 21-May-14 24-May-14 21-May-14 A 27-May-14 A 100% 100% DHCWA18110Construction of Verticals - L17 2.00 25-May-14 26-May-14 28-May-14 A 30-May-14 A 100% 100% STAIRCASES 4.00 10-Aug-14 13-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0% A1520 Stair # 1 4.00 10-Aug-14 13-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% A1530 Stair # 2 3.00 11-Aug-14 13-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% LEVEL 18 81.00 15-May-14 20-Aug-14 15-May-14 A 31-Jul-14 A 100% 100% STRUCTURAL WORKS -LEVEL 18 16.00 15-May-14 03-Jun-14 15-May-14 A 05-Jun-14 A 100% 100% DHCWA19100Core Wall - Level 18 5.00 15-May-14 20-May-14 15-May-14 A 19-May-14 A 100% 100% DHSLA18100Construction of Horizontals - L18 3.00 29-May-14 01-Jun-14 28-May-14 A 03-Jun-14 A 100% 100% DHCWA19110Construction of Verticals - L18 2.00 02-Jun-14 03-Jun-14 04-Jun-14 A 05-Jun-14 A 100% 100% STAIRCASES 4.00 17-Aug-14 20-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0% A1540 Stair # 1 4.00 17-Aug-14 20-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% A1550 Stair # 2 3.00 18-Aug-14 20-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% LEVEL 19 106.00 21-May-14 27-Aug-14 20-May-14 A 31-Jul-14 A 100% 100% STRUCTURAL WORKS -LEVEL 19 106.00 21-May-14 09-Jun-14 20-May-14 A 12-Jun-14 A 100% 100% DHCWA20120Tower Crane Jump 1.00 26-May-14 26-May-14 20-May-14 A 20-May-14 A 100% 100% DHCWA20100Core Wall - Level 19 5.00 21-May-14 26-May-14 20-May-14 A 26-May-14 A 100% 100% DHSLA191000Construction of Horizontals - L19 3.00 04-Jun-14 07-Jun-14 04-Jun-14 A 09-Jun-14 A 100% 100% DHCWA20110Construction of Verticals - L19 2.00 08-Jun-14 09-Jun-14 10-Jun-14 A 12-Jun-14 A 100% 100% STAIRCASES 4.00 24-Aug-14 27-Aug-14 30-Jul-14 A 31-Jul-14 A 0% 0% A1560 Stair # 1 4.00 24-Aug-14 27-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% A1570 Stair # 2 3.00 25-Aug-14 27-Aug-14 30-Jul-14 A 31-Jul-14 A 100% 100% LEVEL 20 84.00 28-May-14 04-Sep-14 27-May-14 A 06-Aug-14 A 100% 100% STRUCTURAL WORKS - LEVEL 20 16.00 28-May-14 15-Jun-14 27-May-14 A 18-Jun-14 A 100% 100% DHCWA21100Core Wall - Level 20 4.00 28-May-14 01-Jun-14 27-May-14 A 31-May-14 A 100% 100% DHSLA20100Construction of Horizontals - L20 3.00 10-Jun-14 12-Jun-14 11-Jun-14 A 14-Jun-14 A 100% 100% DHCWA21110Construction of Verticals - L20 2.00 14-Jun-14 15-Jun-14 15-Jun-14 A 18-Jun-14 A 100% 100% STAIRCASES 4.00 01-Sep-14 04-Sep-14 02-Aug-14 A 06-Aug-14 A 0% 0% A1580 Stair # 1 4.00 01-Sep-14 04-Sep-14 02-Aug-14 A 06-Aug-14 A 100% 100% A1590 Stair # 2 3.00 02-Sep-14 04-Sep-14 02-Aug-14 A 06-Aug-14 A 100% 100% LEVEL 21 85.00 02-Jun-14 10-Sep-14 01-Jun-14 A 12-Aug-14 A 100% 100% STRUCTURAL WORKS - LEVEL 21 17.00 02-Jun-14 21-Jun-14 01-Jun-14 A 24-Jun-14 A 100% 100% DHCWA22100Core Wall - Level 21 4.00 02-Jun-14 05-Jun-14 01-Jun-14 A 06-Jun-14 A 100% 100% DHSLA21100Construction of Horizontals - L21 3.00 16-Jun-14 18-Jun-14 18-Jun-14 A 21-Jun-14 A 100% 100% DHCWA22110Construction of Verticals - L21 2.00 19-Jun-14 21-Jun-14 22-Jun-14 A 24-Jun-14 A 100% 100% STAIRCASES 4.00 07-Sep-14 10-Sep-14 07-Aug-14 A 12-Aug-14 A 0% 0% A1600 Stair # 1 4.00 07-Sep-14 10-Sep-14 07-Aug-14 A 12-Aug-14 A 100% 100% A1610 Stair # 2 3.00 08-Sep-14 10-Sep-14 07-Aug-14 A 12-Aug-14 A 100% 100% LEVEL 22 81.00 12-Jun-14 16-Sep-14 07-Jun-14 A 26-Aug-14 A 100% 100% STRUCTURAL WORKS - LEVEL 22 13.00 12-Jun-14 26-Jun-14 07-Jun-14 A 30-Jun-14 A 100% 100% DHCWA23100Core Wall - Level 22 4.00 12-Jun-14 16-Jun-14 07-Jun-14 A 10-Jun-14 A 100% 100% DHSLA22100Construction of Horizontals - L22 3.00 22-Jun-14 24-Jun-14 24-Jun-14 A 27-Jun-14 A 100% 100% DHCWA23110Construction of Verticals - L22 2.00 25-Jun-14 26-Jun-14 28-Jun-14 A 30-Jun-14 A 100% 100% STAIRCASES 4.00 13-Sep-14 16-Sep-14 13-Aug-14 A 26-Aug-14 A 0% 0% A1620 Stair # 1 4.00 13-Sep-14 16-Sep-14 13-Aug-14 A 18-Aug-14 A 100% 100% A1630 Stair # 2 3.00 14-Sep-14 16-Sep-14 23-Aug-14 A 26-Aug-14 A 100% 100% LEVEL 23 84.00 17-Jun-14 21-Sep-14 12-Jun-14 A 23-Aug-14 A 100% 100% STRUCTURAL WORKS - LEVEL 23 84.00 17-Jun-14 06-Jul-14 12-Jun-14 A 08-Jul-14 A 100% 100% 2014 2015 2016 2017 M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F Core Wall - Level 17 Construction of Horizontals - L17 Construction of Verticals - L17 Stair # 1 Stair # 2 Core Wall - Level 18 Construction of Horizontals - L18 Construction of Verticals - L18 Stair # 1 Stair # 2 Tower Crane Jump Core Wall - Level 19 Construction of Horizontals - L19 Construction of Verticals - L19 Stair # 1 Stair # 2 Core Wall - Level 20 Construction of Horizontals - L20 Construction of Verticals - L20 Stair # 1 Stair # 2 Core Wall - Level 21 Construction of Horizontals - L21 Construction of Verticals - L21 Stair # 1 Stair # 2 Core Wall - Level 22 Construction of Horizontals - L22 Construction of Verticals - L22 Stair # 1 Stair # 2 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 6 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 110.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F DHCWA24100Core Wall - Level 23 4.00 17-Jun-14 21-Jun-14 12-Jun-14 A 15-Jun-14 A 100% 100% DHCWA24120Tower Crane Jump 1.00 21-Jun-14 21-Jun-14 17-Jun-14 A 17-Jun-14 A 100% 100% DHSLA23100Construction of Horizontals- L23 5.00 28-Jun-14 02-Jul-14 27-Jun-14 A 04-Jul-14 A 100% 100% DHCWA24110Construction of Verticals - L23 3.00 03-Jul-14 06-Jul-14 04-Jul-14 A 08-Jul-14 A 100% 100% STAIRCASES 4.00 17-Sep-14 21-Sep-14 18-Aug-14 A 23-Aug-14 A 0% 0% A1640 Stair # 1 4.00 17-Sep-14 21-Sep-14 18-Aug-14 A 23-Aug-14 A 100% 100% A1650 Stair # 2 3.00 18-Sep-14 21-Sep-14 18-Aug-14 A 23-Aug-14 A 100% 100% LEVEL 24 81.00 22-Jun-14 25-Sep-14 17-Jun-14 A 30-Aug-14 A 100% 100% STRUCTURAL WORKS - LEVEL 24 20.00 22-Jun-14 14-Jul-14 17-Jun-14 A 14-Jul-14 A 100% 100% DHCWA25100Core Wall - Level 24 8.00 22-Jun-14 30-Jun-14 17-Jun-14 A 19-Jun-14 A 100% 100% DHSLA24100Construction of Horizontals - L24 4.00 07-Jul-14 10-Jul-14 04-Jul-14 A 10-Jul-14 A 100% 100% DHCWA25110Construction of Verticals - L24 3.00 12-Jul-14 14-Jul-14 10-Jul-14 A 14-Jul-14 A 100% 100% STAIRCASES 4.00 22-Sep-14 25-Sep-14 24-Aug-14 A 30-Aug-14 A 0% 0% A1660 Stair # 1 4.00 22-Sep-14 25-Sep-14 24-Aug-14 A 30-Aug-14 A 100% 100% A1670 Stair # 2 3.00 23-Sep-14 25-Sep-14 24-Aug-14 A 30-Aug-14 A 100% 100% LEVEL 25 78.00 01-Jul-14 01-Oct-14 21-Jun-14 A 04-Sep-14 A 100% 100% STRUCTURAL WORKS - LEVEL 25 18.00 01-Jul-14 21-Jul-14 21-Jun-14 A 19-Jul-14 A 100% 100% DHCWA26100Core Wall - Level 25 5.00 01-Jul-14 06-Jul-14 21-Jun-14 A 26-Jun-14 A 100% 100% DHSLA25100Construction of Horizontals - L25 4.00 15-Jul-14 19-Jul-14 10-Jul-14 A 17-Jul-14 A 100% 100% DHCWA26110Construction of Verticals - L25 2.00 20-Jul-14 21-Jul-14 17-Jul-14 A 19-Jul-14 A 100% 100% STAIRCASES 4.00 28-Sep-14 01-Oct-14 01-Sep-14 A 04-Sep-14 A 0% 0% A1680 Stair # 1 4.00 28-Sep-14 01-Oct-14 01-Sep-14 A 04-Sep-14 A 75% 100% A1690 Stair # 2 3.00 29-Sep-14 01-Oct-14 01-Sep-14 A 04-Sep-14 A 66.67% 100% LEVEL 26 78.00 07-Jul-14 09-Oct-14 27-Jun-14 A 08-Sep-14 A 100% 100% STRUCTURAL WORKS - LEVEL 26 19.00 07-Jul-14 30-Jul-14 27-Jun-14 A 26-Jul-14 A 100% 100% DHCWA27100Core Wall - Level 26 6.00 07-Jul-14 13-Jul-14 27-Jun-14 A 03-Jul-14 A 100% 100% DHSLA26100Construction of Horizontals - L26 4.00 22-Jul-14 26-Jul-14 17-Jul-14 A 23-Jul-14 A 100% 100% DHCWA27110Construction of Verticals - L26 2.00 27-Jul-14 30-Jul-14 22-Jul-14 A 26-Jul-14 A 100% 100% STAIRCASES 4.00 06-Oct-14 09-Oct-14 05-Sep-14 A 08-Sep-14 A 0% 0% A1700 Stair # 1 4.00 06-Oct-14 09-Oct-14 05-Sep-14 A 08-Sep-14 A 0% 100% A1710 Stair # 2 3.00 07-Oct-14 09-Oct-14 05-Sep-14 A 08-Sep-14 A 0% 100% LEVEL 27 76.00 14-Jul-14 14-Oct-14 04-Jul-14 A 14-Sep-14 A 100% 100% STRUCTURAL WORKS - LEVEL 27 61.00 14-Jul-14 05-Aug-14 04-Jul-14 A 05-Aug-14 A 100% 100% DHCWA28100Core Wall - L27 6.00 14-Jul-14 20-Jul-14 04-Jul-14 A 14-Jul-14 A 100% 100% DHCWA28120Tower Crane Jump 1.00 20-Jul-14 20-Jul-14 15-Jul-14 A 17-Jul-14 A 100% 100% DHSLA27100Construction of Horizontals - L27 3.00 31-Jul-14 03-Aug-14 27-Jul-14 A 31-Jul-14 A 100% 100% DHCWA28110Construction of Verticals - L27 2.00 04-Aug-14 05-Aug-14 04-Aug-14 A 05-Aug-14 A 100% 100% STAIRCASES 4.00 11-Oct-14 14-Oct-14 09-Sep-14 A 14-Sep-14 A 0% 0% A1720 Stair # 1 4.00 11-Oct-14 14-Oct-14 09-Sep-14 A 14-Sep-14 A 0% 100% A1730 Stair # 2 3.00 11-Oct-14 13-Oct-14 09-Sep-14 A 14-Sep-14 A 0% 100% LEVEL 28 76.00 21-Jul-14 19-Oct-14 15-Jul-14 A 21-Oct-14 100% 100% 50.00 STRUCTURAL WORKS - LEVEL 28 18.00 21-Jul-14 12-Aug-14 15-Jul-14 A 11-Aug-14 A 100% 100% DHCWA29100Core Wall - L28 6.00 21-Jul-14 27-Jul-14 15-Jul-14 A 21-Jul-14 A 100% 100% DHSLA28100Construction of Horizontals - L28 3.00 06-Aug-14 09-Aug-14 06-Aug-14 A 09-Aug-14 A 100% 100% DHCWA29110Construction of Verticals - L28 3.00 10-Aug-14 12-Aug-14 10-Aug-14 A 11-Aug-14 A 100% 100% STAIRCASES 4.00 15-Oct-14 19-Oct-14 18-Oct-14 21-Oct-14 0% 0% 50.00 A1740 Stair # 1 4.00 15-Oct-14 19-Oct-14 18-Oct-14 21-Oct-14 0% 0% 13.00 A1750 Stair # 2 3.00 15-Oct-14 18-Oct-14 19-Oct-14 21-Oct-14 0% 0% 50.00 2014 2015 2016 2017 Core Wall - Level 23 Tower Crane Jump Construction of Horizontals- L23 Construction of Verticals - L23 Stair # 1 Stair # 2 Core Wall - Level 24 Construction of Horizontals - L24 Construction of Verticals - L24 Stair # 1 Stair # 2 Core Wall - Level 25 Construction of Horizontals - L25 Construction of Verticals - L25 Stair # 1 Stair # 2 Core Wall - Level 26 Construction of Horizontals - L26 Construction of Verticals - L26 Stair # 1 Stair # 2 Core Wall - L27 Tower Crane Jump Construction of Horizontals - L27 Construction of Verticals - L27 Stair # 1 Stair # 2 Core Wall - L28 Construction of Horizontals - L28 Construction of Verticals - L28 Stair # 1 Stair # 2 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 7 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 111.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F LEVEL 29 74.00 30-Jul-14 23-Oct-14 22-Jul-14 A 27-Oct-14 100% 100% 50.00 STRUCTURAL WORKS - LEVEL 29 18.00 30-Jul-14 19-Aug-14 22-Jul-14 A 16-Aug-14 A 100% 100% DHCWA30100Core Wall - L29 5.00 30-Jul-14 04-Aug-14 22-Jul-14 A 27-Jul-14 A 100% 100% DHSLA29100Construction of Horizontals - L29 3.00 13-Aug-14 16-Aug-14 12-Aug-14 A 14-Aug-14 A 100% 100% DHCWA30110Construction of Verticals - L29 3.00 17-Aug-14 19-Aug-14 15-Aug-14 A 16-Aug-14 A 100% 100% STAIRCASES 4.00 19-Oct-14 23-Oct-14 22-Oct-14 27-Oct-14 0% 0% 50.00 A1760 Stair # 1 4.00 20-Oct-14 23-Oct-14 22-Oct-14 27-Oct-14 0% 0% 13.00 A1770 Stair # 2 4.00 19-Oct-14 22-Oct-14 22-Oct-14 27-Oct-14 0% 0% 50.00 LEVELS 30 (MECHANICAL FLOOR) 74.00 05-Aug-14 29-Oct-14 28-Jul-14 A 02-Nov-14 100% 100% 49.00 LEVEL 30 (MECHANICAL FLOOR) 74.00 05-Aug-14 29-Oct-14 28-Jul-14 A 02-Nov-14 100% 100% 49.00 STRUCTURAL WORKS - LEVEL 30 45.00 05-Aug-14 26-Aug-14 28-Jul-14 A 28-Aug-14 A 100% 100% DHCWA31100Core Wall - L30 6.00 05-Aug-14 11-Aug-14 28-Jul-14 A 13-Aug-14 A 100% 100% DHCWA31120Tower Crane Jump 1.00 05-Aug-14 05-Aug-14 20-Aug-14 A 20-Aug-14 A 100% 100% DHSLA30100Construction of Horizontals - L30 (Mech Floor) 3.00 20-Aug-14 23-Aug-14 17-Aug-14 A 22-Aug-14 A 100% 100% DHCWA31110Construction of Verticals - L30 (Mech Floor) 3.00 24-Aug-14 26-Aug-14 23-Aug-14 A 28-Aug-14 A 100% 100% STAIRCASES 4.00 26-Oct-14 29-Oct-14 29-Oct-14 02-Nov-14 0% 0% 49.00 A1780 Stair # 1 4.00 26-Oct-14 29-Oct-14 29-Oct-14 02-Nov-14 0% 0% 12.00 A1790 Stair # 2 4.00 26-Oct-14 29-Oct-14 29-Oct-14 02-Nov-14 0% 0% 49.00 LEVELS 31 - 61 197.00 12-Aug-14 30-Mar-15 14-Aug-14 A 04-Apr-15 22.1% 20.3% 35.00 LEVEL 31 73.00 12-Aug-14 03-Nov-14 14-Aug-14 A 08-Nov-14 100% 100% 47.00 STRUCTURAL WORKS - LEVEL 31 19.00 12-Aug-14 02-Sep-14 14-Aug-14 A 02-Sep-14 A 100% 100% DHCWA32100Core Wall - L31 6.00 12-Aug-14 18-Aug-14 14-Aug-14 A 17-Aug-14 A 100% 100% DHSLA31100Construction of Horizontals - L31 4.00 27-Aug-14 31-Aug-14 29-Aug-14 A 31-Aug-14 A 100% 100% DHCWA32110Construction of Verticals - L31 2.00 01-Sep-14 02-Sep-14 31-Aug-14 A 02-Sep-14 A 100% 100% STAIRCASES 4.00 30-Oct-14 03-Nov-14 04-Nov-14 08-Nov-14 0% 0% 47.00 A1800 Stair # 1 4.00 30-Oct-14 03-Nov-14 04-Nov-14 08-Nov-14 0% 0% 11.00 A1810 Stair # 2 3.00 01-Nov-14 03-Nov-14 05-Nov-14 08-Nov-14 0% 0% 47.00 LEVEL 32 72.00 19-Aug-14 09-Nov-14 19-Aug-14 A 13-Nov-14 100% 100% 45.00 STRUCTURAL WORKS - LEVEL 32 18.00 19-Aug-14 08-Sep-14 19-Aug-14 A 09-Sep-14 A 100% 100% DHCWA33100Core Wall - L32 4.00 19-Aug-14 23-Aug-14 19-Aug-14 A 24-Aug-14 A 100% 100% DHSLA32100Construction of Horizontals - L32 4.00 02-Sep-14 06-Sep-14 02-Sep-14 A 07-Sep-14 A 100% 100% DHCWA33110Construction of Verticals - L32 2.00 07-Sep-14 08-Sep-14 08-Sep-14 A 09-Sep-14 A 100% 100% STAIRCASES 4.00 05-Nov-14 09-Nov-14 10-Nov-14 13-Nov-14 0% 0% 45.00 A1820 Stair # 1 4.00 05-Nov-14 09-Nov-14 10-Nov-14 13-Nov-14 0% 0% 10.00 A1830 Stair # 2 3.00 06-Nov-14 09-Nov-14 11-Nov-14 13-Nov-14 0% 0% 45.00 LEVEL 33 72.00 24-Aug-14 13-Nov-14 24-Aug-14 A 18-Nov-14 100% 100% 44.00 STRUCTURAL WORKS - LEVEL 33 19.00 24-Aug-14 14-Sep-14 24-Aug-14 A 14-Sep-14 A 100% 100% DHCWA34100Core Wall - L33 5.00 24-Aug-14 28-Aug-14 24-Aug-14 A 28-Aug-14 A 100% 100% DHSLA33100Construction of Horizontals - L33 4.00 08-Sep-14 11-Sep-14 10-Sep-14 A 12-Sep-14 A 100% 100% DHCWA34110Construction of Verticals - L33 2.00 13-Sep-14 14-Sep-14 13-Sep-14 A 14-Sep-14 A 100% 100% STAIRCASES 4.00 10-Nov-14 13-Nov-14 15-Nov-14 18-Nov-14 0% 0% 44.00 A1840 Stair # 1 4.00 10-Nov-14 13-Nov-14 15-Nov-14 18-Nov-14 0% 0% 10.00 A1850 Stair # 2 3.00 11-Nov-14 13-Nov-14 16-Nov-14 18-Nov-14 0% 0% 44.00 LEVEL 34 72.00 30-Aug-14 19-Nov-14 30-Aug-14 A 24-Nov-14 100% 100% 42.00 STRUCTURAL WORKS - LEVEL 34 25.00 30-Aug-14 18-Sep-14 30-Aug-14 A 21-Sep-14 A 100% 100% DHCWA35100Core Wall - L34 5.00 30-Aug-14 03-Sep-14 30-Aug-14 A 03-Sep-14 A 100% 100% DHCWA35120Tower Crane Jump 1.00 30-Aug-14 30-Aug-14 06-Sep-14 A 07-Sep-14 A 100% 100% DHSLA34100Construction of Horizontals - L34 4.00 13-Sep-14 16-Sep-14 15-Sep-14 A 18-Sep-14 A 100% 100% DHCWA35110Construction of Verticals - L34 2.00 17-Sep-14 18-Sep-14 20-Sep-14 A 21-Sep-14 A 100% 100% 2014 2015 2016 2017 Core Wall - L29 Construction of Horizontals - L29 Construction of Verticals - L29 Stair # 1 Stair # 2 Core Wall - L30 Tower Crane Jump Construction of Horizontals - L30 (Mech Floor) Construction of Verticals - L30 (Mech Floor) Stair # 1 Stair # 2 Core Wall - L31 Construction of Horizontals - L31 Construction of Verticals - L31 Stair # 1 Stair # 2 Core Wall - L32 Construction of Horizontals - L32 Construction of Verticals - L32 Stair # 1 Stair # 2 Core Wall - L33 Construction of Horizontals - L33 Construction of Verticals - L33 Stair # 1 Stair # 2 Core Wall - L34 Tower Crane Jump Construction of Horizontals - L34 Construction of Verticals - L34 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 8 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 112.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F STAIRCASES 4.00 16-Nov-14 19-Nov-14 20-Nov-14 24-Nov-14 0% 0% 42.00 A1860 Stair # 1 4.00 16-Nov-14 19-Nov-14 20-Nov-14 24-Nov-14 0% 0% 9.00 A1870 Stair # 2 3.00 17-Nov-14 19-Nov-14 22-Nov-14 24-Nov-14 0% 0% 42.00 LEVEL 35 72.00 04-Sep-14 25-Nov-14 04-Sep-14 A 30-Nov-14 100% 100% 41.00 STRUCTURAL WORKS - LEVEL 35 21.00 04-Sep-14 23-Sep-14 04-Sep-14 A 27-Sep-14 A 100% 100% DHCWA36100Core Wall - L35 4.00 04-Sep-14 08-Sep-14 04-Sep-14 A 14-Sep-14 A 100% 100% DHSLA35100Construction of Horizontals - L35 4.00 17-Sep-14 21-Sep-14 22-Sep-14 A 24-Sep-14 A 100% 100% DHCWA36110Construction of Verticals - L35 2.00 22-Sep-14 23-Sep-14 25-Sep-14 A 27-Sep-14 A 100% 100% STAIRCASES 4.00 22-Nov-14 25-Nov-14 26-Nov-14 30-Nov-14 0% 0% 41.00 A1880 Stair # 1 4.00 22-Nov-14 25-Nov-14 26-Nov-14 30-Nov-14 0% 0% 8.00 A1890 Stair # 2 4.00 22-Nov-14 25-Nov-14 26-Nov-14 30-Nov-14 0% 0% 41.00 LEVEL 36 72.00 09-Sep-14 30-Nov-14 15-Sep-14 A 06-Dec-14 100% 86.19% 41.00 STRUCTURAL WORKS - LEVEL 36 21.00 09-Sep-14 29-Sep-14 15-Sep-14 A 01-Oct-14 100% 86.19% -1.00 DHCWA37100Core Wall - L36 7.00 09-Sep-14 16-Sep-14 15-Sep-14 A 17-Sep-14 A 100% 100% DHSLA36100Construction of Horizontals - L36 4.00 23-Sep-14 27-Sep-14 28-Sep-14 A 30-Sep-14 A 100% 100% DHCWA37110Construction of Verticals - L36 2.00 28-Sep-14 29-Sep-14 30-Sep-14 A 01-Oct-14 100% 50% -1.00 STAIRCASES 4.00 26-Nov-14 30-Nov-14 01-Dec-14 06-Dec-14 0% 0% 41.00 A1900 Stair # 1 4.00 26-Nov-14 30-Nov-14 01-Dec-14 06-Dec-14 0% 0% 8.00 A1910 Stair # 2 4.00 26-Nov-14 30-Nov-14 01-Dec-14 06-Dec-14 0% 0% 41.00 LEVEL 37 64.00 17-Sep-14 06-Dec-14 18-Sep-14 A 10-Dec-14 48.36% 24.34% 41.00 STRUCTURAL WORKS - LEVEL 37 14.00 17-Sep-14 07-Oct-14 18-Sep-14 A 11-Oct-14 48.36% 24.34% -2.00 DHCWA38100Core Wall - L37 5.00 17-Sep-14 22-Sep-14 18-Sep-14 A 25-Sep-14 A 100% 100% DHCWA38120Tower Crane Jump 1.00 17-Sep-14 17-Sep-14 01-Oct-14 01-Oct-14 100% 0% -4.00 DHSLA37100Construction of Horizontals - L37 4.00 29-Sep-14 02-Oct-14 02-Oct-14 08-Oct-14 50% 0% -2.00 DHCWA38110Construction of Verticals - L37 2.00 06-Oct-14 07-Oct-14 09-Oct-14 11-Oct-14 0% 0% -2.00 STAIRCASES 4.00 01-Dec-14 06-Dec-14 07-Dec-14 10-Dec-14 0% 0% 41.00 A1920 Stair # 1 4.00 01-Dec-14 06-Dec-14 07-Dec-14 10-Dec-14 0% 0% 8.00 A1930 Stair # 2 4.00 01-Dec-14 06-Dec-14 07-Dec-14 10-Dec-14 0% 0% 41.00 LEVEL 38 66.00 23-Sep-14 10-Dec-14 27-Sep-14 A 15-Dec-14 24.38% 24.38% 41.00 STRUCTURAL WORKS - LEVEL 38 15.00 23-Sep-14 11-Oct-14 27-Sep-14 A 14-Oct-14 24.38% 24.38% -2.00 DHCWA39100Core Wall - L38 4.00 23-Sep-14 27-Sep-14 27-Sep-14 A 29-Sep-14 A 100% 100% DHSLA38100Construction of Horizontals - L38 3.00 06-Oct-14 08-Oct-14 09-Oct-14 12-Oct-14 0% 0% -2.00 DHCWA39110Construction of Verticals - L38 2.00 09-Oct-14 11-Oct-14 13-Oct-14 14-Oct-14 0% 0% -2.00 STAIRCASES 4.00 07-Dec-14 10-Dec-14 11-Dec-14 15-Dec-14 0% 0% 41.00 A1940 Stair # 1 4.00 07-Dec-14 10-Dec-14 11-Dec-14 15-Dec-14 0% 0% 8.00 A1950 Stair # 2 4.00 07-Dec-14 10-Dec-14 11-Dec-14 15-Dec-14 0% 0% 41.00 LEVEL 39 66.00 28-Sep-14 15-Dec-14 30-Sep-14 A 20-Dec-14 18.25% 0% 41.00 STRUCTURAL WORKS - LEVEL 39 15.00 28-Sep-14 15-Oct-14 30-Sep-14 A 19-Oct-14 18.25% 0% -2.00 DHCWA40100Core Wall - L39 4.00 28-Sep-14 01-Oct-14 30-Sep-14 A 08-Oct-14 75% 0% -4.00 DHSLA39100Construction of Horizontals - L39 4.00 09-Oct-14 13-Oct-14 13-Oct-14 16-Oct-14 0% 0% -2.00 DHCWA40110Construction of Verticals - L39 2.00 14-Oct-14 15-Oct-14 18-Oct-14 19-Oct-14 0% 0% -2.00 STAIRCASES 4.00 11-Dec-14 15-Dec-14 16-Dec-14 20-Dec-14 0% 0% 41.00 A1960 Stair # 1 4.00 11-Dec-14 15-Dec-14 16-Dec-14 20-Dec-14 0% 0% 8.00 A1970 Stair # 2 4.00 11-Dec-14 15-Dec-14 16-Dec-14 20-Dec-14 0% 0% 41.00 LEVEL 40 64.00 02-Oct-14 20-Dec-14 09-Oct-14 24-Dec-14 0% 0% 40.00 STRUCTURAL WORKS - LEVEL 40 13.00 02-Oct-14 20-Oct-14 09-Oct-14 23-Oct-14 0% 0% -2.00 DHCWA41100Core Wall - L40 4.00 02-Oct-14 08-Oct-14 09-Oct-14 13-Oct-14 0% 0% -4.00 DHSLA40100Construction of Horizontals - L40 4.00 14-Oct-14 18-Oct-14 18-Oct-14 21-Oct-14 0% 0% -2.00 DHCWA41110Construction of Verticals - L40 2.00 19-Oct-14 20-Oct-14 22-Oct-14 23-Oct-14 0% 0% -2.00 2014 2015 2016 2017 Stair # 1 Stair # 2 Core Wall - L35 Construction of Horizontals - L35 Construction of Verticals - L35 Stair # 1 Stair # 2 Core Wall - L36 Construction of Horizontals - L36 Construction of Verticals - L36 Stair # 1 Stair # 2 Core Wall - L37 Tower Crane Jump Construction of Horizontals - L37 Construction of Verticals - L37 Stair # 1 Stair # 2 Core Wall - L38 Construction of Horizontals - L38 Construction of Verticals - L38 Stair # 1 Stair # 2 Core Wall - L39 Construction of Horizontals - L39 Construction of Verticals - L39 Stair # 1 Stair # 2 Core Wall - L40 Construction of Horizontals - L40 Construction of Verticals - L40 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 9 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 113.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F STAIRCASES 4.00 16-Dec-14 20-Dec-14 21-Dec-14 24-Dec-14 0% 0% 40.00 A1990 Stair # 2 3.00 16-Dec-14 18-Dec-14 21-Dec-14 23-Dec-14 0% 0% 41.00 A1980 Stair # 1 4.00 16-Dec-14 20-Dec-14 21-Dec-14 24-Dec-14 0% 0% 8.00 LEVEL 41 64.00 09-Oct-14 24-Dec-14 14-Oct-14 29-Dec-14 0% 0% 40.00 STRUCTURAL WORKS - LEVEL 41 14.00 09-Oct-14 27-Oct-14 14-Oct-14 30-Oct-14 0% 0% -2.00 DHCWA42120Tower Crane Jump 1.00 09-Oct-14 09-Oct-14 14-Oct-14 14-Oct-14 0% 0% -1.00 DHCWA42100Core Wall - L41 4.00 09-Oct-14 13-Oct-14 14-Oct-14 18-Oct-14 0% 0% -4.00 DHSLA41100Construction of Horizontals - L41 4.00 20-Oct-14 23-Oct-14 23-Oct-14 28-Oct-14 0% 0% -2.00 DHCWA42110Construction of Verticals - L41 2.00 26-Oct-14 27-Oct-14 29-Oct-14 30-Oct-14 0% 0% -2.00 STAIRCASES 5.00 20-Dec-14 24-Dec-14 24-Dec-14 29-Dec-14 0% 0% 40.00 A2010 Stair # 2 4.00 20-Dec-14 23-Dec-14 24-Dec-14 28-Dec-14 0% 0% 41.00 A2000 Stair # 1 4.00 21-Dec-14 24-Dec-14 25-Dec-14 29-Dec-14 0% 0% 8.00 LEVEL 42 64.00 14-Oct-14 29-Dec-14 19-Oct-14 04-Jan-15 0% 0% 40.00 STRUCTURAL WORKS - LEVEL 42 15.00 14-Oct-14 01-Nov-14 19-Oct-14 05-Nov-14 0% 0% -4.00 DHCWA43100Core Wall - L42 5.00 14-Oct-14 19-Oct-14 19-Oct-14 23-Oct-14 0% 0% -4.00 DHSLA42100Construction of Horizontals - L42 4.00 26-Oct-14 29-Oct-14 30-Oct-14 03-Nov-14 0% 0% -4.00 DHCWA43110Construction of Verticals - L42 2.00 30-Oct-14 01-Nov-14 04-Nov-14 05-Nov-14 0% 0% -4.00 STAIRCASES 5.00 24-Dec-14 29-Dec-14 29-Dec-14 04-Jan-15 0% 0% 40.00 A2030 Stair # 2 4.00 24-Dec-14 28-Dec-14 29-Dec-14 03-Jan-15 0% 0% 41.00 A2020 Stair # 1 4.00 25-Dec-14 29-Dec-14 30-Dec-14 04-Jan-15 0% 0% 8.00 LEVEL 43 63.00 20-Oct-14 04-Jan-15 26-Oct-14 08-Jan-15 0% 0% 40.00 STRUCTURAL WORKS - LEVEL 43 15.00 20-Oct-14 06-Nov-14 26-Oct-14 11-Nov-14 0% 0% -4.00 DHCWA44100Core Wall - L43 4.00 20-Oct-14 23-Oct-14 26-Oct-14 29-Oct-14 0% 0% -4.00 DHSLA43100Construction of Horizontals - L43 4.00 01-Nov-14 04-Nov-14 05-Nov-14 09-Nov-14 0% 0% -4.00 DHCWA44110Construction of Verticals - L43 2.00 05-Nov-14 06-Nov-14 10-Nov-14 11-Nov-14 0% 0% -4.00 STAIRCASES 5.00 29-Dec-14 04-Jan-15 04-Jan-15 08-Jan-15 0% 0% 40.00 A2050 Stair # 2 4.00 29-Dec-14 03-Jan-15 04-Jan-15 07-Jan-15 0% 0% 41.00 A2040 Stair # 1 4.00 30-Dec-14 04-Jan-15 05-Jan-15 08-Jan-15 0% 0% 8.00 LEVEL 44 63.00 26-Oct-14 08-Jan-15 30-Oct-14 13-Jan-15 0% 0% 40.00 STRUCTURAL WORKS - LEVEL 44 15.00 26-Oct-14 11-Nov-14 30-Oct-14 16-Nov-14 0% 0% -4.00 DHCWA45100Core Wall - L44 4.00 26-Oct-14 29-Oct-14 30-Oct-14 03-Nov-14 0% 0% -4.00 DHSLA44100Construction of Horizontals - L44 4.00 05-Nov-14 09-Nov-14 10-Nov-14 13-Nov-14 0% 0% -4.00 DHCWA45110Construction of Verticals - L44 2.00 10-Nov-14 11-Nov-14 15-Nov-14 16-Nov-14 0% 0% -4.00 STAIRCASES 5.00 04-Jan-15 08-Jan-15 08-Jan-15 13-Jan-15 0% 0% 40.00 A2070 Stair # 2 4.00 04-Jan-15 07-Jan-15 08-Jan-15 12-Jan-15 0% 0% 41.00 A2060 Stair # 1 4.00 05-Jan-15 08-Jan-15 10-Jan-15 13-Jan-15 0% 0% 8.00 LEVEL 45 63.00 30-Oct-14 13-Jan-15 04-Nov-14 18-Jan-15 0% 0% 40.00 STRUCTURAL WORKS - LEVEL 45 16.00 30-Oct-14 17-Nov-14 04-Nov-14 22-Nov-14 0% 0% -4.00 DHCWA46120Tower Crane Jump 1.00 30-Oct-14 30-Oct-14 04-Nov-14 04-Nov-14 0% 0% -1.00 DHCWA46100Core Wall - L45 4.00 30-Oct-14 03-Nov-14 04-Nov-14 08-Nov-14 0% 0% -4.00 DHSLA45100Construction of Horizontals - L45 4.00 11-Nov-14 15-Nov-14 16-Nov-14 19-Nov-14 0% 0% -4.00 DHCWA46110Construction of Verticals - L45 2.00 16-Nov-14 17-Nov-14 20-Nov-14 22-Nov-14 0% 0% -4.00 STAIRCASES 5.00 08-Jan-15 13-Jan-15 13-Jan-15 18-Jan-15 0% 0% 40.00 A2090 Stair # 2 4.00 08-Jan-15 12-Jan-15 13-Jan-15 17-Jan-15 0% 0% 41.00 A2080 Stair # 1 4.00 10-Jan-15 13-Jan-15 14-Jan-15 18-Jan-15 0% 0% 8.00 LEVEL 46 63.00 04-Nov-14 18-Jan-15 09-Nov-14 22-Jan-15 0% 0% 40.00 STRUCTURAL WORKS - LEVEL 46 17.00 04-Nov-14 23-Nov-14 09-Nov-14 27-Nov-14 0% 0% -4.00 DHCWA47100Core Wall - L46 5.00 04-Nov-14 09-Nov-14 09-Nov-14 13-Nov-14 0% 0% -4.00 DHSLA46100Construction of Horizontals - L46 4.00 17-Nov-14 20-Nov-14 22-Nov-14 25-Nov-14 0% 0% -4.00 2014 2015 2016 2017 Stair # 2 Stair # 1 Tower Crane Jump Core Wall - L41 Construction of Horizontals - L41 Construction of Verticals - L41 Stair # 2 Stair # 1 Core Wall - L42 Construction of Horizontals - L42 Construction of Verticals - L42 Stair # 2 Stair # 1 Core Wall - L43 Construction of Horizontals - L43 Construction of Verticals - L43 Stair # 2 Stair # 1 Core Wall - L44 Construction of Horizontals - L44 Construction of Verticals - L44 Stair # 2 Stair # 1 Tower Crane Jump Core Wall - L45 Construction of Horizontals - L45 Construction of Verticals - L45 Stair # 2 Stair # 1 Core Wall - L46 Construction of Horizontals - L46 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 10 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 114.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F DHCWA47110Construction of Verticals - L46 2.00 22-Nov-14 23-Nov-14 26-Nov-14 27-Nov-14 0% 0% -4.00 STAIRCASES 5.00 13-Jan-15 18-Jan-15 18-Jan-15 22-Jan-15 0% 0% 40.00 A2110 Stair # 2 4.00 13-Jan-15 17-Jan-15 18-Jan-15 21-Jan-15 0% 0% 41.00 A2100 Stair # 1 4.00 14-Jan-15 18-Jan-15 19-Jan-15 22-Jan-15 0% 0% 8.00 LEVEL 47 62.00 10-Nov-14 22-Jan-15 15-Nov-14 27-Jan-15 0% 0% 40.00 STRUCTURAL WORKS - LEVEL 47 16.00 10-Nov-14 27-Nov-14 15-Nov-14 03-Dec-14 0% 0% -4.00 DHCWA48100Core Wall - L47 5.00 10-Nov-14 15-Nov-14 15-Nov-14 19-Nov-14 0% 0% -4.00 DHSLA47100Construction of Horizontals - L47 4.00 22-Nov-14 25-Nov-14 26-Nov-14 30-Nov-14 0% 0% -4.00 DHCWA48110Construction of Verticals - L47 2.00 26-Nov-14 27-Nov-14 01-Dec-14 03-Dec-14 0% 0% -4.00 STAIRCASES 5.00 18-Jan-15 22-Jan-15 22-Jan-15 27-Jan-15 0% 0% 40.00 A2130 Stair # 2 4.00 18-Jan-15 21-Jan-15 22-Jan-15 26-Jan-15 0% 0% 41.00 A2120 Stair # 1 4.00 19-Jan-15 22-Jan-15 24-Jan-15 27-Jan-15 0% 0% 8.00 LEVEL 48 61.00 16-Nov-14 27-Jan-15 20-Nov-14 01-Feb-15 0% 0% 40.00 STRUCTURAL WORKS - LEVEL 48 15.00 16-Nov-14 03-Dec-14 20-Nov-14 08-Dec-14 0% 0% -4.00 DHCWA49120Tower Crane Jump 1.00 16-Nov-14 16-Nov-14 20-Nov-14 20-Nov-14 0% 0% -1.00 DHCWA49100Core Wall - L48 4.00 16-Nov-14 19-Nov-14 20-Nov-14 24-Nov-14 0% 0% -4.00 DHSLA48100Construction of Horizontals - L48 4.00 26-Nov-14 30-Nov-14 01-Dec-14 06-Dec-14 0% 0% -4.00 DHCWA49110Construction of Verticals - L48 2.00 01-Dec-14 03-Dec-14 07-Dec-14 08-Dec-14 0% 0% -4.00 STAIRCASES 5.00 22-Jan-15 27-Jan-15 27-Jan-15 01-Feb-15 0% 0% 40.00 A2150 Stair # 2 4.00 22-Jan-15 26-Jan-15 27-Jan-15 31-Jan-15 0% 0% 41.00 A2140 Stair # 1 4.00 24-Jan-15 27-Jan-15 28-Jan-15 01-Feb-15 0% 0% 8.00 LEVEL 49 61.00 20-Nov-14 01-Feb-15 25-Nov-14 05-Feb-15 0% 0% 40.00 STRUCTURAL WORKS - LEVEL 49 14.00 20-Nov-14 07-Dec-14 25-Nov-14 11-Dec-14 0% 0% -4.00 DHCWA50100Core Wall - L49 4.00 20-Nov-14 24-Nov-14 25-Nov-14 29-Nov-14 0% 0% -4.00 DHSLA49100Construction of Horizontals - L49 4.00 30-Nov-14 04-Dec-14 06-Dec-14 09-Dec-14 0% 0% -4.00 DHCWA50110Construction of Verticals - L49 2.00 06-Dec-14 07-Dec-14 10-Dec-14 11-Dec-14 0% 0% -4.00 STAIRCASES 5.00 27-Jan-15 01-Feb-15 01-Feb-15 05-Feb-15 0% 0% 40.00 A2170 Stair # 2 4.00 27-Jan-15 31-Jan-15 01-Feb-15 04-Feb-15 0% 0% 41.00 A2160 Stair # 1 4.00 28-Jan-15 01-Feb-15 02-Feb-15 05-Feb-15 0% 0% 8.00 LEVEL 50 61.00 25-Nov-14 05-Feb-15 30-Nov-14 10-Feb-15 0% 0% 40.00 STRUCTURAL WORKS - LEVEL 50 14.00 25-Nov-14 11-Dec-14 30-Nov-14 16-Dec-14 0% 0% -4.00 DHCWA51100Core Wall - L50 4.00 25-Nov-14 29-Nov-14 30-Nov-14 04-Dec-14 0% 0% -4.00 DHSLA50100Construction of Horizontals - L50 4.00 06-Dec-14 09-Dec-14 10-Dec-14 14-Dec-14 0% 0% -4.00 DHCWA51110Construction of Verticals - L50 2.00 10-Dec-14 11-Dec-14 15-Dec-14 16-Dec-14 0% 0% -4.00 STAIRCASES 5.00 01-Feb-15 05-Feb-15 05-Feb-15 10-Feb-15 0% 0% 40.00 A2190 Stair # 2 4.00 01-Feb-15 04-Feb-15 05-Feb-15 09-Feb-15 0% 0% 41.00 A2180 Stair # 1 4.00 02-Feb-15 05-Feb-15 07-Feb-15 10-Feb-15 0% 0% 8.00 LEVEL 51 61.00 30-Nov-14 10-Feb-15 06-Dec-14 15-Feb-15 0% 0% 40.00 STRUCTURAL WORKS - LEVEL 51 14.00 30-Nov-14 16-Dec-14 06-Dec-14 21-Dec-14 0% 0% -4.00 DHCWA52100Core Wall - L51 4.00 30-Nov-14 04-Dec-14 06-Dec-14 09-Dec-14 0% 0% -4.00 DHSLA51100Construction of Horizontals - L51 4.00 10-Dec-14 14-Dec-14 15-Dec-14 18-Dec-14 0% 0% -4.00 DHCWA52110Construction of Verticals - L51 2.00 15-Dec-14 16-Dec-14 20-Dec-14 21-Dec-14 0% 0% -4.00 STAIRCASES 5.00 05-Feb-15 10-Feb-15 10-Feb-15 15-Feb-15 0% 0% 40.00 A2210 Stair # 2 4.00 05-Feb-15 09-Feb-15 10-Feb-15 14-Feb-15 0% 0% 41.00 A2200 Stair # 1 4.00 07-Feb-15 10-Feb-15 11-Feb-15 15-Feb-15 0% 0% 8.00 LEVEL 52 62.00 06-Dec-14 16-Feb-15 10-Dec-14 21-Feb-15 0% 0% 39.00 STRUCTURAL WORKS - LEVEL 52 14.00 06-Dec-14 21-Dec-14 10-Dec-14 25-Dec-14 0% 0% -4.00 DHCWA53120Tower Crane Jump 1.00 06-Dec-14 06-Dec-14 10-Dec-14 10-Dec-14 0% 0% -1.00 DHCWA53100Core Wall - L52 4.00 06-Dec-14 09-Dec-14 10-Dec-14 14-Dec-14 0% 0% -4.00 2014 2015 2016 2017 Construction of Verticals - L46 Stair # 2 Stair # 1 Core Wall - L47 Construction of Horizontals - L47 Construction of Verticals - L47 Stair # 2 Stair # 1 Tower Crane Jump Core Wall - L48 Construction of Horizontals - L48 Construction of Verticals - L48 Stair # 2 Stair # 1 Core Wall - L49 Construction of Horizontals - L49 Construction of Verticals - L49 Stair # 2 Stair # 1 Core Wall - L50 Construction of Horizontals - L50 Construction of Verticals - L50 Stair # 2 Stair # 1 Core Wall - L51 Construction of Horizontals - L51 Construction of Verticals - L51 Stair # 2 Stair # 1 Tower Crane Jump Core Wall - L52 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 11 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 115.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F DHSLA52100Construction of Horizontals - L52 4.00 15-Dec-14 18-Dec-14 20-Dec-14 23-Dec-14 0% 0% -4.00 DHCWA53110Construction of Verticals - L52 2.00 20-Dec-14 21-Dec-14 24-Dec-14 25-Dec-14 0% 0% -4.00 STAIRCASES 4.00 12-Feb-15 16-Feb-15 17-Feb-15 21-Feb-15 0% 0% 39.00 A2220 Stair # 1 4.00 12-Feb-15 16-Feb-15 17-Feb-15 21-Feb-15 0% 0% 7.00 A2230 Stair # 2 4.00 12-Feb-15 16-Feb-15 17-Feb-15 21-Feb-15 0% 0% 39.00 LEVEL 53 62.00 10-Dec-14 21-Feb-15 15-Dec-14 25-Feb-15 0% 0% 39.00 STRUCTURAL WORKS - LEVEL 53 14.00 10-Dec-14 25-Dec-14 15-Dec-14 30-Dec-14 0% 0% -4.00 DHCWA54100Core Wall - L53 4.00 10-Dec-14 14-Dec-14 15-Dec-14 18-Dec-14 0% 0% -4.00 DHSLA53100Construction of Horizontals - L53 4.00 20-Dec-14 23-Dec-14 24-Dec-14 28-Dec-14 0% 0% -4.00 DHCWA54110Construction of Verticals - L53 2.00 24-Dec-14 25-Dec-14 29-Dec-14 30-Dec-14 0% 0% -4.00 STAIRCASES 4.00 17-Feb-15 21-Feb-15 22-Feb-15 25-Feb-15 0% 0% 39.00 A2240 Stair # 1 4.00 17-Feb-15 21-Feb-15 22-Feb-15 25-Feb-15 0% 0% 7.00 A2250 Stair # 2 4.00 17-Feb-15 21-Feb-15 22-Feb-15 25-Feb-15 0% 0% 39.00 LEVEL 54 62.00 15-Dec-14 25-Feb-15 20-Dec-14 02-Mar-15 0% 0% 39.00 STRUCTURAL WORKS - LEVEL 54 13.00 15-Dec-14 29-Dec-14 20-Dec-14 04-Jan-15 0% 0% -4.00 DHCWA55100Core Wall - L54 4.00 15-Dec-14 18-Dec-14 20-Dec-14 23-Dec-14 0% 0% -4.00 DHSLA54100Construction of Horizontals - L54 4.00 23-Dec-14 27-Dec-14 28-Dec-14 31-Dec-14 0% 0% -4.00 DHCWA55110Construction of Verticals - L54 2.00 28-Dec-14 29-Dec-14 03-Jan-15 04-Jan-15 0% 0% -4.00 STAIRCASES 4.00 22-Feb-15 25-Feb-15 26-Feb-15 02-Mar-15 0% 0% 39.00 A2260 Stair # 1 4.00 22-Feb-15 25-Feb-15 26-Feb-15 02-Mar-15 0% 0% 7.00 A2270 Stair # 2 4.00 22-Feb-15 25-Feb-15 26-Feb-15 02-Mar-15 0% 0% 39.00 LEVEL 55 62.00 20-Dec-14 02-Mar-15 24-Dec-14 07-Mar-15 0% 0% 39.00 STRUCTURAL WORKS - LEVEL 55 13.00 20-Dec-14 04-Jan-15 24-Dec-14 08-Jan-15 0% 0% -4.00 DHCWA56100Core Wall - L55 4.00 20-Dec-14 23-Dec-14 24-Dec-14 28-Dec-14 0% 0% -4.00 DHSLA55100Construction of Horizontals - L55 3.00 29-Dec-14 31-Dec-14 04-Jan-15 06-Jan-15 0% 0% -4.00 DHCWA56110Construction of Verticals - L55 2.00 03-Jan-15 04-Jan-15 07-Jan-15 08-Jan-15 0% 0% -4.00 STAIRCASES 4.00 26-Feb-15 02-Mar-15 03-Mar-15 07-Mar-15 0% 0% 39.00 A2280 Stair # 1 4.00 26-Feb-15 02-Mar-15 03-Mar-15 07-Mar-15 0% 0% 7.00 A2290 Stair # 2 4.00 26-Feb-15 02-Mar-15 03-Mar-15 07-Mar-15 0% 0% 39.00 LEVEL 56 62.00 24-Dec-14 07-Mar-15 29-Dec-14 11-Mar-15 0% 0% 38.00 STRUCTURAL WORKS - LEVEL 56 13.00 24-Dec-14 08-Jan-15 29-Dec-14 13-Jan-15 0% 0% -4.00 DHCWA57120Tower Crane Jump 1.00 24-Dec-14 24-Dec-14 29-Dec-14 29-Dec-14 0% 0% -1.00 DHCWA57100Core Wall - L56 4.00 24-Dec-14 28-Dec-14 29-Dec-14 03-Jan-15 0% 0% -4.00 DHSLA56100Construction of Horizontals - L56 3.00 04-Jan-15 06-Jan-15 08-Jan-15 11-Jan-15 0% 0% -4.00 DHCWA57110Construction of Verticals - L56 2.00 07-Jan-15 08-Jan-15 12-Jan-15 13-Jan-15 0% 0% -4.00 STAIRCASES 4.00 03-Mar-15 07-Mar-15 08-Mar-15 11-Mar-15 0% 0% 38.00 A2310 Stair # 2 3.00 03-Mar-15 05-Mar-15 08-Mar-15 10-Mar-15 0% 0% 39.00 A2300 Stair # 1 4.00 03-Mar-15 07-Mar-15 08-Mar-15 11-Mar-15 0% 0% 7.00 LEVEL 57 62.00 29-Dec-14 11-Mar-15 04-Jan-15 16-Mar-15 0% 0% 38.00 STRUCTURAL WORKS - LEVEL 57 12.00 29-Dec-14 12-Jan-15 04-Jan-15 17-Jan-15 0% 0% -4.00 DHCWA58100Core Wall - L57 3.00 29-Dec-14 31-Dec-14 04-Jan-15 06-Jan-15 0% 0% -4.00 DHSLA57100Construction of Horizontals - L57 4.00 06-Jan-15 10-Jan-15 11-Jan-15 14-Jan-15 0% 0% -4.00 DHCWA58110Construction of Verticals - L57 2.00 11-Jan-15 12-Jan-15 15-Jan-15 17-Jan-15 0% 0% -4.00 STAIRCASES 5.00 07-Mar-15 11-Mar-15 11-Mar-15 16-Mar-15 0% 0% 38.00 A2330 Stair # 2 4.00 07-Mar-15 10-Mar-15 11-Mar-15 15-Mar-15 0% 0% 39.00 A2320 Stair # 1 4.00 08-Mar-15 11-Mar-15 12-Mar-15 16-Mar-15 0% 0% 7.00 LEVEL 58 63.00 03-Jan-15 16-Mar-15 07-Jan-15 21-Mar-15 0% 0% 38.00 STRUCTURAL WORKS - LEVEL 58 13.00 03-Jan-15 17-Jan-15 07-Jan-15 21-Jan-15 0% 0% -4.00 DHCWA59100Core Wall - L58 3.00 03-Jan-15 05-Jan-15 07-Jan-15 10-Jan-15 0% 0% -4.00 2014 2015 2016 2017 Construction of Horizontals - L52 Construction of Verticals - L52 Stair # 1 Stair # 2 Core Wall - L53 Construction of Horizontals - L53 Construction of Verticals - L53 Stair # 1 Stair # 2 Core Wall - L54 Construction of Horizontals - L54 Construction of Verticals - L54 Stair # 1 Stair # 2 Core Wall - L55 Construction of Horizontals - L55 Construction of Verticals - L55 Stair # 1 Stair # 2 Tower Crane Jump Core Wall - L56 Construction of Horizontals - L56 Construction of Verticals - L56 Stair # 2 Stair # 1 Core Wall - L57 Construction of Horizontals - L57 Construction of Verticals - L57 Stair # 2 Stair # 1 Core Wall - L58 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 12 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 116.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F DHSLA58100Construction of Horizontals - L58 4.00 11-Jan-15 14-Jan-15 15-Jan-15 19-Jan-15 0% 0% -4.00 DHCWA59110Construction of Verticals - L58 2.00 15-Jan-15 17-Jan-15 20-Jan-15 21-Jan-15 0% 0% -4.00 STAIRCASES 5.00 11-Mar-15 16-Mar-15 16-Mar-15 21-Mar-15 0% 0% 38.00 A2350 Stair # 2 4.00 11-Mar-15 15-Mar-15 16-Mar-15 19-Mar-15 0% 0% 39.00 A2340 Stair # 1 4.00 12-Mar-15 16-Mar-15 17-Mar-15 21-Mar-15 0% 0% 7.00 LEVEL 59 64.00 06-Jan-15 21-Mar-15 11-Jan-15 25-Mar-15 0% 0% 37.00 STRUCTURAL WORKS - LEVEL 59 13.00 06-Jan-15 20-Jan-15 11-Jan-15 25-Jan-15 0% 0% -4.00 DHCWA60100Core Wall - L59 4.00 06-Jan-15 10-Jan-15 11-Jan-15 14-Jan-15 0% 0% -4.00 DHSLA59100Construction of Horizontals - L59 3.00 15-Jan-15 18-Jan-15 20-Jan-15 22-Jan-15 0% 0% -4.00 DHCWA60110Construction of Verticals - L59 2.00 19-Jan-15 20-Jan-15 24-Jan-15 25-Jan-15 0% 0% -4.00 STAIRCASES 5.00 16-Mar-15 21-Mar-15 21-Mar-15 25-Mar-15 0% 0% 37.00 A2370 Stair # 2 3.00 16-Mar-15 18-Mar-15 21-Mar-15 23-Mar-15 0% 0% 39.00 A2360 Stair # 1 4.00 17-Mar-15 21-Mar-15 22-Mar-15 25-Mar-15 0% 0% 7.00 LEVEL 60 64.00 11-Jan-15 25-Mar-15 15-Jan-15 30-Mar-15 0% 0% 36.00 STRUCTURAL WORKS - LEVEL 60 13.00 11-Jan-15 25-Jan-15 15-Jan-15 29-Jan-15 0% 0% -4.00 DHCWA61120Tower Crane Jump 1.00 11-Jan-15 11-Jan-15 15-Jan-15 15-Jan-15 0% 0% -2.00 DHCWA61100Core Wall - L 60 3.00 11-Jan-15 13-Jan-15 15-Jan-15 18-Jan-15 0% 0% -4.00 DHSLA60100Construction of Horizontal - L60 3.00 20-Jan-15 22-Jan-15 25-Jan-15 27-Jan-15 0% 0% -4.00 DHCWA61110Construction of Verticals - L60 2.00 24-Jan-15 25-Jan-15 28-Jan-15 29-Jan-15 0% 0% -4.00 STAIRCASES 6.00 19-Mar-15 25-Mar-15 24-Mar-15 30-Mar-15 0% 0% 36.00 A2390 Stair # 2 3.00 19-Mar-15 22-Mar-15 24-Mar-15 26-Mar-15 0% 0% 39.00 A2380 Stair # 1 4.00 22-Mar-15 25-Mar-15 26-Mar-15 30-Mar-15 0% 0% 7.00 LEVEL 61 65.00 14-Jan-15 30-Mar-15 19-Jan-15 04-Apr-15 0% 0% 35.00 STRUCTURAL WORKS - LEVEL 61 13.00 14-Jan-15 28-Jan-15 19-Jan-15 02-Feb-15 0% 0% -4.00 DHCWA62100Core Wall - L61 3.00 14-Jan-15 17-Jan-15 19-Jan-15 21-Jan-15 0% 0% -4.00 DHSLA61100Construction of Horizontal - L61 3.00 24-Jan-15 26-Jan-15 28-Jan-15 31-Jan-15 0% 0% -4.00 DHCWA62110Construction of Verticals - L61 2.00 27-Jan-15 28-Jan-15 01-Feb-15 02-Feb-15 0% 0% -4.00 STAIRCASES 7.00 23-Mar-15 30-Mar-15 28-Mar-15 04-Apr-15 0% 0% 35.00 A2410 Stair # 2 3.00 23-Mar-15 25-Mar-15 28-Mar-15 30-Mar-15 0% 0% 39.00 A2400 Stair # 1 4.00 26-Mar-15 30-Mar-15 31-Mar-15 04-Apr-15 0% 0% 7.00 LEVELS 62 (MECHANICAL FLOOR) 66.00 18-Jan-15 04-Apr-15 22-Jan-15 08-Apr-15 0% 0% 34.00 LEVEL 62 66.00 18-Jan-15 04-Apr-15 22-Jan-15 08-Apr-15 0% 0% 34.00 STRUCTURAL WORKS - LEVEL 62 18.00 18-Jan-15 07-Feb-15 22-Jan-15 11-Feb-15 0% 0% -4.00 DHCWA63100Core Wall - L62 6.00 18-Jan-15 24-Jan-15 22-Jan-15 28-Jan-15 0% 0% -4.00 DHSLA62100Construction of Horizontal - L62 ( Mech . Floor ) 5.00 29-Jan-15 03-Feb-15 03-Feb-15 08-Feb-15 0% 0% -4.00 DHCWA63110Construction of Verticals - L62 ( Mech . Floor ) 3.00 04-Feb-15 07-Feb-15 09-Feb-15 11-Feb-15 0% 0% -4.00 STAIRCASES 7.00 28-Mar-15 04-Apr-15 01-Apr-15 08-Apr-15 0% 0% 34.00 A2430 Stair # 2 3.00 28-Mar-15 30-Mar-15 01-Apr-15 04-Apr-15 0% 0% 38.00 A2420 Stair # 1 4.00 31-Mar-15 04-Apr-15 05-Apr-15 08-Apr-15 0% 0% 7.00 LEVELS 63-85 148.00 25-Jan-15 16-Jul-15 29-Jan-15 23-Jul-15 0% 0% 12.00 LEVEL 63 64.00 25-Jan-15 08-Apr-15 29-Jan-15 13-Apr-15 0% 0% 33.00 STRUCTURAL WORKS - LEVEL 63 18.00 25-Jan-15 14-Feb-15 29-Jan-15 18-Feb-15 0% 0% -3.00 DHCWA64100Core Wall - L63 3.00 25-Jan-15 27-Jan-15 29-Jan-15 01-Feb-15 0% 0% -4.00 DHSLA63100Construction of Horizontal - L63 4.00 08-Feb-15 11-Feb-15 12-Feb-15 16-Feb-15 0% 0% -4.00 DHCWA64110Construction of Verticals - L63 2.00 12-Feb-15 14-Feb-15 17-Feb-15 18-Feb-15 0% 0% -3.00 STAIRCASES 8.00 31-Mar-15 08-Apr-15 05-Apr-15 13-Apr-15 0% 0% 33.00 A2450 Stair # 2 3.00 31-Mar-15 02-Apr-15 05-Apr-15 07-Apr-15 0% 0% 38.00 A2440 Stair # 1 4.00 05-Apr-15 08-Apr-15 09-Apr-15 13-Apr-15 0% 0% 7.00 LEVEL 64 65.00 28-Jan-15 13-Apr-15 02-Feb-15 18-Apr-15 0% 0% 32.00 2014 2015 2016 2017 Construction of Horizontals - L58 Construction of Verticals - L58 Stair # 2 Stair # 1 Core Wall - L59 Construction of Horizontals - L59 Construction of Verticals - L59 Stair # 2 Stair # 1 Tower Crane Jump Core Wall - L 60 Construction of Horizontal - L60 Construction of Verticals - L60 Stair # 2 Stair # 1 Core Wall - L61 Construction of Horizontal - L61 Construction of Verticals - L61 Stair # 2 Stair # 1 Core Wall - L62 Construction of Horizontal - L62 ( Mech . Floor ) Construction of Verticals - L62 ( Mech . Floor ) Stair # 2 Stair # 1 Core Wall - L63 Construction of Horizontal - L63 Construction of Verticals - L63 Stair # 2 Stair # 1 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 13 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 117.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F STRUCTURAL WORKS - LEVEL 64 18.00 28-Jan-15 17-Feb-15 02-Feb-15 22-Feb-15 0% 0% -3.00 DHCWA65120Tower Crane Jump 1.00 28-Jan-15 28-Jan-15 02-Feb-15 02-Feb-15 0% 0% 0.00 DHCWA65100Core Wall - L64 5.00 28-Jan-15 02-Feb-15 02-Feb-15 07-Feb-15 0% 0% -4.00 DHSLA64100Construction of Horizontal - L64 3.00 12-Feb-15 15-Feb-15 17-Feb-15 19-Feb-15 0% 0% -3.00 DHCWA65110Construction of Verticals - L64 2.00 16-Feb-15 17-Feb-15 21-Feb-15 22-Feb-15 0% 0% -3.00 STAIRCASES 9.00 04-Apr-15 13-Apr-15 08-Apr-15 18-Apr-15 0% 0% 32.00 A2470 Stair # 2 3.00 04-Apr-15 06-Apr-15 08-Apr-15 11-Apr-15 0% 0% 38.00 A2460 Stair # 1 4.00 09-Apr-15 13-Apr-15 14-Apr-15 18-Apr-15 0% 0% 7.00 LEVEL 65 64.00 03-Feb-15 18-Apr-15 08-Feb-15 22-Apr-15 0% 0% 31.00 STRUCTURAL WORKS - LEVEL 65 17.00 03-Feb-15 22-Feb-15 08-Feb-15 26-Feb-15 0% 0% -3.00 DHCWA66100Core Wall - L65 5.00 03-Feb-15 08-Feb-15 08-Feb-15 12-Feb-15 0% 0% -4.00 DHSLA65100Construction of Horizontals - L65 3.00 17-Feb-15 19-Feb-15 22-Feb-15 24-Feb-15 0% 0% -3.00 DHCWA66110Construction of Verticals - L65 2.00 21-Feb-15 22-Feb-15 25-Feb-15 26-Feb-15 0% 0% -3.00 STAIRCASES 10.00 07-Apr-15 18-Apr-15 12-Apr-15 22-Apr-15 0% 0% 31.00 A2490 Stair # 2 3.00 07-Apr-15 09-Apr-15 12-Apr-15 14-Apr-15 0% 0% 38.00 A2480 Stair # 1 4.00 14-Apr-15 18-Apr-15 19-Apr-15 22-Apr-15 0% 0% 7.00 LEVEL 66 63.00 09-Feb-15 22-Apr-15 14-Feb-15 27-Apr-15 0% 0% 30.00 STRUCTURAL WORKS - LEVEL 66 16.00 09-Feb-15 26-Feb-15 14-Feb-15 03-Mar-15 0% 0% -3.00 DHCWA67100Core Wall - L66 5.00 09-Feb-15 14-Feb-15 14-Feb-15 18-Feb-15 0% 0% -4.00 DHSLA66100Construction of Horizontals - L66 3.00 22-Feb-15 24-Feb-15 26-Feb-15 01-Mar-15 0% 0% -3.00 DHCWA67110Construction of Verticals - L66 2.00 25-Feb-15 26-Feb-15 02-Mar-15 03-Mar-15 0% 0% -3.00 STAIRCASES 11.00 11-Apr-15 22-Apr-15 15-Apr-15 27-Apr-15 0% 0% 30.00 A2510 Stair # 2 3.00 11-Apr-15 13-Apr-15 15-Apr-15 18-Apr-15 0% 0% 38.00 A2500 Stair # 1 4.00 19-Apr-15 22-Apr-15 23-Apr-15 27-Apr-15 0% 0% 7.00 LEVEL 67 62.00 15-Feb-15 27-Apr-15 19-Feb-15 02-May-15 0% 0% 29.00 STRUCTURAL WORKS - LEVEL 67 14.00 15-Feb-15 02-Mar-15 19-Feb-15 07-Mar-15 0% 0% -3.00 DHCWA68120Tower Crane Jump 1.00 15-Feb-15 15-Feb-15 19-Feb-15 19-Feb-15 0% 0% -1.00 DHCWA68100Core Wall - L67 4.00 15-Feb-15 18-Feb-15 19-Feb-15 23-Feb-15 0% 0% -4.00 DHSLA67100Construction of Horizontals - L67 3.00 25-Feb-15 28-Feb-15 02-Mar-15 04-Mar-15 0% 0% -3.00 DHCWA68110Construction of Verticals - L67 2.00 01-Mar-15 02-Mar-15 05-Mar-15 07-Mar-15 0% 0% -3.00 STAIRCASES 12.00 14-Apr-15 27-Apr-15 19-Apr-15 02-May-15 0% 0% 29.00 A2530 Stair # 2 3.00 14-Apr-15 16-Apr-15 19-Apr-15 21-Apr-15 0% 0% 38.00 A2520 Stair # 1 4.00 23-Apr-15 27-Apr-15 28-Apr-15 02-May-15 0% 0% 7.00 LEVEL 68 62.00 19-Feb-15 02-May-15 24-Feb-15 06-May-15 0% 0% 28.00 STRUCTURAL WORKS - LEVEL 68 14.00 19-Feb-15 07-Mar-15 24-Feb-15 11-Mar-15 0% 0% -2.00 DHCWA69100Core Wall - L68 4.00 19-Feb-15 23-Feb-15 24-Feb-15 28-Feb-15 0% 0% -4.00 DHSLA68100Construction of Horizontals - L68 3.00 02-Mar-15 04-Mar-15 07-Mar-15 09-Mar-15 0% 0% -3.00 DHCWA69110Construction of Verticals - L68 2.00 05-Mar-15 07-Mar-15 10-Mar-15 11-Mar-15 0% 0% -2.00 STAIRCASES 13.00 18-Apr-15 02-May-15 22-Apr-15 06-May-15 0% 0% 28.00 A2550 Stair # 2 3.00 18-Apr-15 20-Apr-15 22-Apr-15 25-Apr-15 0% 0% 38.00 A2540 Stair # 1 4.00 28-Apr-15 02-May-15 03-May-15 06-May-15 0% 0% 7.00 LEVEL 69 62.00 24-Feb-15 06-May-15 01-Mar-15 11-May-15 0% 0% 27.00 STRUCTURAL WORKS - LEVEL 69 14.00 24-Feb-15 11-Mar-15 01-Mar-15 16-Mar-15 0% 0% -2.00 DHCWA70100Core Wall - L69 4.00 24-Feb-15 28-Feb-15 01-Mar-15 04-Mar-15 0% 0% -4.00 DHSLA69100Construction of Horizontals - L69 3.00 07-Mar-15 09-Mar-15 11-Mar-15 14-Mar-15 0% 0% -2.00 DHCWA70110Construction of Verticals - L69 2.00 10-Mar-15 11-Mar-15 15-Mar-15 16-Mar-15 0% 0% -2.00 STAIRCASES 13.00 22-Apr-15 06-May-15 27-Apr-15 11-May-15 0% 0% 27.00 A2570 Stair # 2 3.00 22-Apr-15 25-Apr-15 27-Apr-15 29-Apr-15 0% 0% 37.00 2014 2015 2016 2017 Tower Crane Jump Core Wall - L64 Construction of Horizontal - L64 Construction of Verticals - L64 Stair # 2 Stair # 1 Core Wall - L65 Construction of Horizontals - L65 Construction of Verticals - L65 Stair # 2 Stair # 1 Core Wall - L66 Construction of Horizontals - L66 Construction of Verticals - L66 Stair # 2 Stair # 1 Tower Crane Jump Core Wall - L67 Construction of Horizontals - L67 Construction of Verticals - L67 Stair # 2 Stair # 1 Core Wall - L68 Construction of Horizontals - L68 Construction of Verticals - L68 Stair # 2 Stair # 1 Core Wall - L69 Construction of Horizontals - L69 Construction of Verticals - L69 Stair # 2 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 14 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 118.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F A2560 Stair # 1 4.00 03-May-15 06-May-15 07-May-15 11-May-15 0% 0% 7.00 LEVEL 70 62.00 01-Mar-15 11-May-15 05-Mar-15 17-May-15 0% 0% 26.00 STRUCTURAL WORKS - LEVEL 70 13.00 01-Mar-15 15-Mar-15 05-Mar-15 19-Mar-15 0% 0% -2.00 DHCWA71120Tower Crane Jump 1.00 01-Mar-15 01-Mar-15 05-Mar-15 05-Mar-15 0% 0% 0.00 DHCWA71100Core Wall - L70 5.00 01-Mar-15 05-Mar-15 05-Mar-15 10-Mar-15 0% 0% -4.00 DHSLA70100Construction of Horizontals - L70 3.00 10-Mar-15 12-Mar-15 15-Mar-15 17-Mar-15 0% 0% -2.00 DHCWA71110Construction of Verticals - L70 2.00 14-Mar-15 15-Mar-15 18-Mar-15 19-Mar-15 0% 0% -2.00 STAIRCASES 14.00 26-Apr-15 11-May-15 30-Apr-15 17-May-15 0% 0% 26.00 A2590 Stair # 2 3.00 26-Apr-15 28-Apr-15 30-Apr-15 03-May-15 0% 0% 37.00 A2580 Stair # 1 4.00 07-May-15 11-May-15 12-May-15 17-May-15 0% 0% 7.00 LEVEL 71 61.00 07-Mar-15 17-May-15 11-Mar-15 21-May-15 0% 0% 25.00 STRUCTURAL WORKS - LEVEL 71 11.00 07-Mar-15 18-Mar-15 11-Mar-15 23-Mar-15 0% 0% -2.00 DHCWA72100Core Wall - L71 4.00 07-Mar-15 10-Mar-15 11-Mar-15 15-Mar-15 0% 0% -4.00 DHSLA71100Construction of Horizontals - L71 3.00 14-Mar-15 16-Mar-15 18-Mar-15 21-Mar-15 0% 0% -2.00 DHCWA72110Construction of Verticals - L71 2.00 17-Mar-15 18-Mar-15 22-Mar-15 23-Mar-15 0% 0% -2.00 STAIRCASES 15.00 29-Apr-15 17-May-15 04-May-15 21-May-15 0% 0% 25.00 A2610 Stair # 2 3.00 29-Apr-15 02-May-15 04-May-15 06-May-15 0% 0% 37.00 A2600 Stair # 1 4.00 12-May-15 17-May-15 18-May-15 21-May-15 0% 0% 7.00 LEVEL 72 61.00 11-Mar-15 21-May-15 16-Mar-15 26-May-15 0% 0% 24.00 STRUCTURAL WORKS - LEVEL 72 11.00 11-Mar-15 23-Mar-15 16-Mar-15 28-Mar-15 0% 0% -3.00 DHCWA73100Core Wall - L72 4.00 11-Mar-15 15-Mar-15 16-Mar-15 19-Mar-15 0% 0% -4.00 DHSLA72100Construction of Horizontals - L72 3.00 18-Mar-15 21-Mar-15 23-Mar-15 25-Mar-15 0% 0% -3.00 DHCWA73110Construction of Verticals - L72 2.00 22-Mar-15 23-Mar-15 26-Mar-15 28-Mar-15 0% 0% -3.00 STAIRCASES 16.00 03-May-15 21-May-15 07-May-15 26-May-15 0% 0% 24.00 A2630 Stair # 2 3.00 03-May-15 05-May-15 07-May-15 10-May-15 0% 0% 37.00 A2620 Stair # 1 4.00 18-May-15 21-May-15 23-May-15 26-May-15 0% 0% 7.00 LEVEL 73 61.00 16-Mar-15 26-May-15 21-Mar-15 31-May-15 0% 0% 23.00 STRUCTURAL WORKS - LEVEL 73 11.00 16-Mar-15 28-Mar-15 21-Mar-15 01-Apr-15 0% 0% -4.00 DHCWA74100Core Wall - L73 4.00 16-Mar-15 19-Mar-15 21-Mar-15 24-Mar-15 0% 0% -4.00 DHSLA73100Construction of Horizontals - L73 3.00 23-Mar-15 25-Mar-15 28-Mar-15 30-Mar-15 0% 0% -4.00 DHCWA74110Construction of Verticals - L73 2.00 26-Mar-15 28-Mar-15 31-Mar-15 01-Apr-15 0% 0% -4.00 STAIRCASES 17.00 06-May-15 26-May-15 11-May-15 31-May-15 0% 0% 23.00 A2650 Stair # 2 3.00 06-May-15 09-May-15 11-May-15 13-May-15 0% 0% 37.00 A2640 Stair # 1 4.00 23-May-15 26-May-15 27-May-15 31-May-15 0% 0% 7.00 LEVEL 74 61.00 21-Mar-15 31-May-15 25-Mar-15 04-Jun-15 0% 0% 22.00 STRUCTURAL WORKS - LEVEL 74 10.00 21-Mar-15 31-Mar-15 25-Mar-15 05-Apr-15 0% 0% -4.00 DHCWA75120Tower Crane Jump 1.00 21-Mar-15 21-Mar-15 25-Mar-15 25-Mar-15 0% 0% -1.00 DHCWA75100Core Wall - L74 4.00 21-Mar-15 24-Mar-15 25-Mar-15 29-Mar-15 0% 0% -4.00 DHSLA74100Construction of Horizontals - L74 3.00 26-Mar-15 29-Mar-15 31-Mar-15 02-Apr-15 0% 0% -4.00 DHCWA75110Construction of Verticals - L74 2.00 30-Mar-15 31-Mar-15 04-Apr-15 05-Apr-15 0% 0% -4.00 STAIRCASES 18.00 10-May-15 31-May-15 14-May-15 04-Jun-15 0% 0% 22.00 A2670 Stair # 2 3.00 10-May-15 12-May-15 14-May-15 18-May-15 0% 0% 37.00 A2660 Stair # 1 4.00 27-May-15 31-May-15 01-Jun-15 04-Jun-15 0% 0% 7.00 LEVEL 75 61.00 25-Mar-15 04-Jun-15 30-Mar-15 09-Jun-15 0% 0% 21.00 STRUCTURAL WORKS - LEVEL 75 9.00 25-Mar-15 04-Apr-15 30-Mar-15 08-Apr-15 0% 0% -4.00 DHCWA76100Core Wall - L75 3.00 25-Mar-15 28-Mar-15 30-Mar-15 01-Apr-15 0% 0% -4.00 DHSLA75100Construction of Horizontals - L75 3.00 30-Mar-15 01-Apr-15 04-Apr-15 06-Apr-15 0% 0% -4.00 DHCWA76110Construction of Verticals - L75 2.00 02-Apr-15 04-Apr-15 07-Apr-15 08-Apr-15 0% 0% -4.00 STAIRCASES 19.00 13-May-15 04-Jun-15 19-May-15 09-Jun-15 0% 0% 21.00 2014 2015 2016 2017 Stair # 1 Tower Crane Jump Core Wall - L70 Construction of Horizontals - L70 Construction of Verticals - L70 Stair # 2 Stair # 1 Core Wall - L71 Construction of Horizontals - L71 Construction of Verticals - L71 Stair # 2 Stair # 1 Core Wall - L72 Construction of Horizontals - L72 Construction of Verticals - L72 Stair # 2 Stair # 1 Core Wall - L73 Construction of Horizontals - L73 Construction of Verticals - L73 Stair # 2 Stair # 1 Tower Crane Jump Core Wall - L74 Construction of Horizontals - L74 Construction of Verticals - L74 Stair # 2 Stair # 1 Core Wall - L75 Construction of Horizontals - L75 Construction of Verticals - L75 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 15 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 119.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F A2690 Stair # 2 3.00 13-May-15 17-May-15 19-May-15 21-May-15 0% 0% 37.00 A2680 Stair # 1 4.00 01-Jun-15 04-Jun-15 06-Jun-15 09-Jun-15 0% 0% 7.00 LEVEL 76 62.00 29-Mar-15 09-Jun-15 02-Apr-15 14-Jun-15 0% 0% 20.00 STRUCTURAL WORKS - LEVEL 76 9.00 29-Mar-15 07-Apr-15 02-Apr-15 12-Apr-15 0% 0% -4.00 DHCWA77100Core Wall - L76 3.00 29-Mar-15 31-Mar-15 02-Apr-15 05-Apr-15 0% 0% -4.00 DHSLA76100Construction of Horizontals - L76 3.00 02-Apr-15 05-Apr-15 07-Apr-15 09-Apr-15 0% 0% -4.00 DHCWA77110Construction of Verticals - L76 2.00 06-Apr-15 07-Apr-15 11-Apr-15 12-Apr-15 0% 0% -4.00 STAIRCASES 20.00 18-May-15 09-Jun-15 23-May-15 14-Jun-15 0% 0% 20.00 A2710 Stair # 2 3.00 18-May-15 20-May-15 23-May-15 25-May-15 0% 0% 37.00 A2700 Stair # 1 4.00 06-Jun-15 09-Jun-15 10-Jun-15 14-Jun-15 0% 0% 7.00 LEVEL 77 63.00 01-Apr-15 14-Jun-15 06-Apr-15 18-Jun-15 0% 0% 19.00 STRUCTURAL WORKS - LEVEL 77 9.00 01-Apr-15 11-Apr-15 06-Apr-15 15-Apr-15 0% 0% -4.00 DHCWA78100Core Wall - L77 3.00 01-Apr-15 04-Apr-15 06-Apr-15 08-Apr-15 0% 0% -4.00 DHSLA77100Construction of Horizontals - L77 3.00 06-Apr-15 08-Apr-15 11-Apr-15 13-Apr-15 0% 0% -4.00 DHCWA78110Construction of Verticals - L77 2.00 09-Apr-15 11-Apr-15 14-Apr-15 15-Apr-15 0% 0% -4.00 STAIRCASES 21.00 21-May-15 14-Jun-15 26-May-15 18-Jun-15 0% 0% 19.00 A2730 Stair # 2 3.00 21-May-15 24-May-15 26-May-15 28-May-15 0% 0% 37.00 A2720 Stair # 1 4.00 10-Jun-15 14-Jun-15 15-Jun-15 18-Jun-15 0% 0% 7.00 LEVEL 78 64.00 05-Apr-15 18-Jun-15 09-Apr-15 23-Jun-15 0% 0% 18.00 STRUCTURAL WORKS - LEVEL 78 9.00 05-Apr-15 14-Apr-15 09-Apr-15 19-Apr-15 0% 0% -4.00 DHCWA79140Tower Crane Jump 1.00 05-Apr-15 05-Apr-15 09-Apr-15 09-Apr-15 0% 0% -2.00 DHCWA79100Core Wall - L78 3.00 05-Apr-15 07-Apr-15 09-Apr-15 12-Apr-15 0% 0% -4.00 DHSLA78100Construction of Horizontals - L78 3.00 09-Apr-15 12-Apr-15 14-Apr-15 16-Apr-15 0% 0% -4.00 DHCWA79110Construction of Verticals - L78 2.00 13-Apr-15 14-Apr-15 18-Apr-15 19-Apr-15 0% 0% -4.00 STAIRCASES 22.00 25-May-15 18-Jun-15 30-May-15 23-Jun-15 0% 0% 18.00 A2750 Stair # 2 3.00 25-May-15 27-May-15 30-May-15 01-Jun-15 0% 0% 37.00 A2740 Stair # 1 4.00 15-Jun-15 18-Jun-15 20-Jun-15 23-Jun-15 0% 0% 7.00 LEVEL 79 65.00 08-Apr-15 23-Jun-15 13-Apr-15 28-Jun-15 0% 0% 17.00 STRUCTURAL WORKS - LEVEL 79 9.00 08-Apr-15 18-Apr-15 13-Apr-15 22-Apr-15 0% 0% -4.00 DHCWA80100Core Wall - L79 3.00 08-Apr-15 11-Apr-15 13-Apr-15 15-Apr-15 0% 0% -4.00 DHSLA79100Construction of Horizontals - L79 3.00 13-Apr-15 15-Apr-15 18-Apr-15 20-Apr-15 0% 0% -4.00 DHCWA80110Construction of Verticals - L79 2.00 16-Apr-15 18-Apr-15 21-Apr-15 22-Apr-15 0% 0% -4.00 STAIRCASES 23.00 28-May-15 23-Jun-15 02-Jun-15 28-Jun-15 0% 0% 17.00 A2770 Stair # 2 3.00 28-May-15 31-May-15 02-Jun-15 04-Jun-15 0% 0% 37.00 A2760 Stair # 1 4.00 20-Jun-15 23-Jun-15 24-Jun-15 28-Jun-15 0% 0% 7.00 LEVEL 80 66.00 12-Apr-15 28-Jun-15 16-Apr-15 02-Jul-15 0% 0% 16.00 STRUCTURAL WORKS - LEVEL 80 10.00 12-Apr-15 22-Apr-15 16-Apr-15 27-Apr-15 0% 0% -4.00 DHCWA81100Core Wall - Level 80 3.00 12-Apr-15 14-Apr-15 16-Apr-15 19-Apr-15 0% 0% -4.00 DHSLA80100Construction of Horizontals - L80 3.00 18-Apr-15 20-Apr-15 22-Apr-15 25-Apr-15 0% 0% -4.00 DHCWA81110Construction of Verticals - L80 2.00 21-Apr-15 22-Apr-15 26-Apr-15 27-Apr-15 0% 0% -4.00 STAIRCASES 24.00 01-Jun-15 28-Jun-15 06-Jun-15 02-Jul-15 0% 0% 16.00 A2790 Stair # 2 3.00 01-Jun-15 03-Jun-15 06-Jun-15 08-Jun-15 0% 0% 37.00 A2780 Stair # 1 4.00 24-Jun-15 28-Jun-15 29-Jun-15 02-Jul-15 0% 0% 7.00 LEVEL 81 67.00 15-Apr-15 02-Jul-15 20-Apr-15 07-Jul-15 0% 0% 15.00 STRUCTURAL WORKS - LEVEL 81 10.00 15-Apr-15 26-Apr-15 20-Apr-15 30-Apr-15 0% 0% -4.00 DHCWA78120Core Wall - L81 3.00 15-Apr-15 18-Apr-15 20-Apr-15 22-Apr-15 0% 0% -4.00 DHSLA811000Construction of Horizontals - L81 3.00 21-Apr-15 23-Apr-15 26-Apr-15 28-Apr-15 0% 0% -4.00 DHCWA78130Construction of Verticals - L81 2.00 25-Apr-15 26-Apr-15 29-Apr-15 30-Apr-15 0% 0% -4.00 STAIRCASES 25.00 04-Jun-15 02-Jul-15 09-Jun-15 07-Jul-15 0% 0% 15.00 2014 2015 2016 2017 Stair # 2 Stair # 1 Core Wall - L76 Construction of Horizontals - L76 Construction of Verticals - L76 Stair # 2 Stair # 1 Core Wall - L77 Construction of Horizontals - L77 Construction of Verticals - L77 Stair # 2 Stair # 1 Tower Crane Jump Core Wall - L78 Construction of Horizontals - L78 Construction of Verticals - L78 Stair # 2 Stair # 1 Core Wall - L79 Construction of Horizontals - L79 Construction of Verticals - L79 Stair # 2 Stair # 1 Core Wall - Level 80 Construction of Horizontals - L80 Construction of Verticals - L80 Stair # 2 Stair # 1 Core Wall - L81 Construction of Horizontals - L81 Construction of Verticals - L81 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 16 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 120.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F A2900 Stair # 2 3.00 04-Jun-15 07-Jun-15 09-Jun-15 11-Jun-15 0% 0% 37.00 A2890 Stair # 1 4.00 29-Jun-15 02-Jul-15 04-Jul-15 07-Jul-15 0% 0% 7.00 LEVEL 82 68.00 19-Apr-15 07-Jul-15 23-Apr-15 12-Jul-15 0% 0% 14.00 STRUCTURAL WORKS - LEVEL 82 10.00 19-Apr-15 29-Apr-15 23-Apr-15 04-May-15 0% 0% -4.00 DHCWA79150Tower Crane Jump 1.00 19-Apr-15 19-Apr-15 23-Apr-15 23-Apr-15 0% 0% -2.00 DHCWA79120Core Wall - L82 3.00 19-Apr-15 21-Apr-15 23-Apr-15 26-Apr-15 0% 0% -4.00 DHSLA821000Construction of Horizontals - L82 3.00 25-Apr-15 27-Apr-15 29-Apr-15 02-May-15 0% 0% -4.00 DHCWA79130Construction of Verticals - L82 2.00 28-Apr-15 29-Apr-15 03-May-15 04-May-15 0% 0% -4.00 STAIRCASES 26.00 08-Jun-15 07-Jul-15 13-Jun-15 12-Jul-15 0% 0% 14.00 A2920 Stair # 2 3.00 08-Jun-15 10-Jun-15 13-Jun-15 15-Jun-15 0% 0% 37.00 A2910 Stair # 1 4.00 04-Jul-15 07-Jul-15 08-Jul-15 12-Jul-15 0% 0% 7.00 LEVEL 83 69.00 22-Apr-15 12-Jul-15 27-Apr-15 16-Jul-15 0% 0% 13.00 STRUCTURAL WORKS - LEVEL 83 10.00 22-Apr-15 03-May-15 27-Apr-15 07-May-15 0% 0% -4.00 DHCWA80120Core Wall - L83 3.00 22-Apr-15 25-Apr-15 27-Apr-15 29-Apr-15 0% 0% -4.00 DHSLA831000Construction of Horizontals - L83 2.00 29-Apr-15 30-Apr-15 04-May-15 05-May-15 0% 0% -4.00 DHCWA80130Construction of Verticals - L83 2.00 02-May-15 03-May-15 06-May-15 07-May-15 0% 0% -4.00 STAIRCASES 27.00 11-Jun-15 12-Jul-15 16-Jun-15 16-Jul-15 0% 0% 13.00 A2940 Stair # 2 3.00 11-Jun-15 14-Jun-15 16-Jun-15 18-Jun-15 0% 0% 37.00 A2930 Stair # 1 4.00 08-Jul-15 12-Jul-15 13-Jul-15 16-Jul-15 0% 0% 7.00 LEVEL 84 70.00 26-Apr-15 16-Jul-15 30-Apr-15 23-Jul-15 0% 0% 12.00 STRUCTURAL WORKS - LEVEL 84 10.00 26-Apr-15 06-May-15 30-Apr-15 11-May-15 0% 0% -4.00 DHCWA81150Core Wall - Level 84 4.00 26-Apr-15 29-Apr-15 30-Apr-15 04-May-15 0% 0% -4.00 DHSLA841000Construction of Horizontals - L84 2.00 03-May-15 04-May-15 07-May-15 09-May-15 0% 0% -4.00 DHCWA81160Construction of Verticals - L84 2.00 05-May-15 06-May-15 10-May-15 11-May-15 0% 0% -4.00 STAIRCASES 28.00 15-Jun-15 16-Jul-15 20-Jun-15 23-Jul-15 0% 0% 12.00 A2960 Stair # 2 3.00 15-Jun-15 17-Jun-15 20-Jun-15 22-Jun-15 0% 0% 37.00 A2950 Stair # 1 4.00 13-Jul-15 16-Jul-15 20-Jul-15 23-Jul-15 0% 0% 7.00 LEVEL 85(MECHANICAL FLOOR) 70.00 30-Apr-15 23-Jul-15 05-May-15 28-Jul-15 0% 0% 12.00 LEVEL 85 70.00 30-Apr-15 23-Jul-15 05-May-15 28-Jul-15 0% 0% 12.00 STRUCTURAL WORKS - LEVEL 85 8.00 30-Apr-15 09-May-15 05-May-15 13-May-15 0% 0% -4.00 DHCWA81170Tower Crane Jump 1.00 30-Apr-15 30-Apr-15 05-May-15 05-May-15 0% 0% 0.00 DHCWA81120Core Wall - Level 85 4.00 30-Apr-15 04-May-15 05-May-15 09-May-15 0% 0% -4.00 DHSLA851000Construction of Horizontals - L85(Mech Floor) 4.00 04-May-15 07-May-15 09-May-15 12-May-15 0% 0% -4.00 DHCWA81130Construction of Verticals - L85 (Mech Floor) 1.00 09-May-15 09-May-15 13-May-15 13-May-15 0% 0% -4.00 STAIRCASES 29.00 18-Jun-15 23-Jul-15 23-Jun-15 28-Jul-15 0% 0% 12.00 A2810 Stair # 2 4.00 18-Jun-15 22-Jun-15 23-Jun-15 27-Jun-15 0% 0% 37.00 A2800 Stair # 1 4.00 20-Jul-15 23-Jul-15 25-Jul-15 28-Jul-15 0% 0% 7.00 LEVEL 86 TO ROOF 82.00 06-May-15 12-Aug-15 11-May-15 17-Aug-15 0% 0% 7.00 LEVEL 86 66.00 10-May-15 28-Jul-15 14-May-15 02-Aug-15 0% 0% 12.00 STRUCTURAL WORKS - LEVEL 86 3.00 10-May-15 12-May-15 14-May-15 18-May-15 0% 0% -4.00 DHSLA861000Construction of Horizontals - L86 2.00 10-May-15 11-May-15 14-May-15 17-May-15 0% 0% -4.00 DHCWA81140Construction of Verticals - L86 1.00 12-May-15 12-May-15 18-May-15 18-May-15 0% 0% -4.00 STAIRCASES 29.00 23-Jun-15 28-Jul-15 28-Jun-15 02-Aug-15 0% 0% 12.00 A2830 Stair # 2 4.00 23-Jun-15 27-Jun-15 28-Jun-15 01-Jul-15 0% 0% 37.00 A2820 Stair # 1 4.00 25-Jul-15 28-Jul-15 29-Jul-15 02-Aug-15 0% 0% 7.00 ROOF & TOP OF ROOF 82.00 06-May-15 12-Aug-15 11-May-15 17-Aug-15 0% 0% 7.00 STRUCTURAL WORKS - LEVEL 87 & Above 8.00 06-May-15 14-May-15 11-May-15 20-May-15 0% 0% -4.00 DHCWA82100Core Wall - Level RF,URF 4.00 06-May-15 10-May-15 11-May-15 14-May-15 0% 0% -4.00 DHSLA871000Construction of Roof Deck Slab L87 1.00 13-May-15 13-May-15 19-May-15 19-May-15 0% 0% -4.00 2014 2015 2016 2017 Stair # 2 Stair # 1 Tower Crane Jump Core Wall - L82 Construction of Horizontals - L82 Construction of Verticals - L82 Stair # 2 Stair # 1 Core Wall - L83 Construction of Horizontals - L83 Construction of Verticals - L83 Stair # 2 Stair # 1 Core Wall - Level 84 Construction of Horizontals - L84 Construction of Verticals - L84 Stair # 2 Stair # 1 Tower Crane Jump Core Wall - Level 85 Construction of Horizontals - L85(Mech Floor) Construction of Verticals - L85 (Mech Floor) Stair # 2 Stair # 1 Construction of Horizontals - L86 Construction of Verticals - L86 Stair # 2 Stair # 1 Core Wall - Level RF,URF Construction of Roof Deck Slab L87 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 17 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 121.
    Activity ID ActivityName Current Duration Planned Start Planned Finish Actual/Forecast Start Actual/Forecast Finish Planned % Complete Actual % Complete Total Float M A M J Jul A S O N D J F M A M J Jul A S O N D J F M A M J Jul A S O N D J F DHSLA881000Construction of Top of Roof Slab-L88 2.00 13-May-15 14-May-15 19-May-15 20-May-15 0% 0% -4.00 STAIRCASES 38.00 28-Jun-15 12-Aug-15 02-Jul-15 17-Aug-15 0% 0% 7.00 A2850 Stair # 2 4.00 28-Jun-15 01-Jul-15 02-Jul-15 06-Jul-15 0% 0% 37.00 A2840 Stair # 1 4.00 09-Aug-15 12-Aug-15 13-Aug-15 17-Aug-15 0% 0% 7.00 2014 2015 2016 2017 Construction of Top of Roof Slab-L88 Stair # 2 Stair # 1 DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Data Date : 30-Sep-14 Page : 18 of 18 Printed On : 16-Oct-14 Baseline Actual Work Remaining Work Critical Remaining Work Baseline Milestone Curernt Milestone Damac Heights Tower at Dubai Marina Project Progress Update as of 30-Sep-2014 Delay in the Structure[ Date Revision Checked Approved 20-Aug... Target Completion Programme - Rev 03 (Basel... 30-Sep... Schedule Update - September-14 (Update) SK
  • 122.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 3 Core Walls and Slabs Cycles
  • 123.
    Gain/Loss (Days) Gain/Loss(Days) Gain/Loss (Days) Total Last Period Current Week DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Core Wal - L06 6 15-Feb-14 20-Feb-14 0 - 20-Feb-14 - - Core Wal - L07 9 20-Feb-14 5-Mar-14 0 13.00 28-Feb-14 8.00 5.00 5.00 Core Wal - L08 9 6-Mar-14 16-Mar-14 0 11.00 11-Mar-14 11.00 - - Weekly Movement Planned Actual / Forecast Progress Analysis Core Walls Cycles Core Wall Levels Original Duration Planned Start Date Planned Finish Date Total Float Critical Planned Cycle Actual Finish Date Actual Cycle Forecast Finish Date Core Wall - L09 10 17-Mar-14 27-Mar-14 0 11.00 23-Mar-14 12.00 (1.00) (1.00) Core Wall - L10 4 29-Mar-14 1-Apr-14 0 5.00 31-Mar-14 8.00 (3.00) (3.00) Core Wall - L11 4 2-Apr-14 6-Apr-14 0 5.00 8-Apr-14 8.00 (3.00) (3.00) Core Wall - L12 6 7-Apr-14 13-Apr-14 0 7.00 14-Apr-14 6.00 1.00 1.00 Core Wall - L13 4 14-Apr-14 17-Apr-14 0 4.00 20-Apr-14 6.00 (2.00) (2.00) Core Wall - L14 4 19-Apr-14 22-Apr-14 0 5.00 27-Apr-14 7.00 (2.00) (2.00) Core Wall - L15 9 23-Apr-14 3-May-14 0 11.00 5-May-14 8.00 3.00 3.00 Core Wall - L16 5 4-May-14 8-May-14 0 5.00 8-May-14 3.00 2.00 2.00 Core Wall - L17 5 10-May-14 14-May-14 0 6.00 14-May-14 6.00 - - Core Wall - L18 5 15-May-14 20-May-14 0 6.00 19-May-14 5.00 1.00 1.00 Core Wall - L19 5 21-May-14 26-May-14 0 6.00 26-May-14 7.00 (1.00) (1.00) Core Wall - L20 4 28-May-14 1-Jun-14 0 6.00 31-May-14 5.00 1.00 1.00 Core Wall - L21 4 2-Jun-14 5-Jun-14 0 4.00 6-Jun-14 6.00 (2.00) (2.00) Core Wall - L 22 4 12-Jun-14 16-Jun-14 0 11.00 10-Jun-14 4.00 7.00 7.00 Core Wall - L23 4 17-Jun-14 21-Jun-14 0 5.00 15-Jun-14 5.00 - - Core Wall - L24 8 22-Jun-14 30-Jun-14 0 9.00 19-Jun-14 4.00 5.00 5.00 Core Wall - L25 5 1-Jul-14 6-Jul-14 0 6.00 26-Jun-14 7.00 (1.00) (1.00) Core Wall - L26 6 7-Jul-14 13-Jul-14 0 7.00 3-Jul-14 7.00 - - Core Wall - L27 6 14-Jul-14 20-Jul-14 0 7.00 14-Jul-14 11.00 (4.00) (4.00) Core Wall - L28 6 21-Jul-14 27-Jul-14 0 7.00 21-Jul-14 7.00 - - Core Wall - L29 5 30-Jul-14 4-Aug-14 0 8.00 27-Jul-14 6.00 2.00 2.00 Core Wall - L30 6 5-Aug-14 11-Aug-14 0 7.00 13-Aug-14 17.00 (10.00) (10.00) Core Wall - L31 6 12-Aug-14 18-Aug-14 0 7.00 17-Aug-14 4.00 3.00 3.00 Core Wall - L32 4 19-Aug-14 23-Aug-14 0 5.00 24-Aug-14 7.00 (2.00) (2.00) Core Wall - L33 5 24-Aug-14 28-Aug-14 0 5.00 28-Aug-14 4.00 1.00 1.00 Core Wall - L34 5 30-Aug-14 3-Sep-14 0 6.00 3-Sep-14 6.00 - - Core Wall - L35 4 4-Sep-14 8-Sep-14 0 5.00 14-Sep-14 11.00 (6.00) (6.00) Core Wall - L36 7 9-Sep-14 16-Sep-14 0 8.00 17-Sep-14 3.00 5.00 5.00 Core Wall - L37 5 17-Sep-14 22-Sep-14 0 6.00 25-Sep-14 8.00 (2.00) (2.00) Core Wall - L38 4 23-Sep-14 27-Sep-14 0 5.00 29-Sep-14 4.00 1.00 1.00 Core Wall - L39 4 28-Sep-14 1-Oct-14 0 4.00 3-Oct-14 Core Wall - L40 4 2-Oct-14 8-Oct-14 0 7.00 10-Oct-14 Core Wall - L41 4 9-Oct-14 13-Oct-14 0 5.00 15-Oct-14 Core Wall - L42 5 14-Oct-14 19-Oct-14 0 6.00 21-Oct-14 Core Wall - L43 4 20-Oct-14 23-Oct-14 0 4.00 25-Oct-14 Core Wall - L44 4 26-Oct-14 29-Oct-14 0 6.00 31-Oct-14 Core Wall - L45 4 30-Oct-14 3-Nov-14 0 5.00 5-Nov-14 Core Wall - L46 5 4-Nov-14 9-Nov-14 0 6.00 11-Nov-14 Core Wall - L47 5 10-Nov-14 15-Nov-14 0 6.00 17-Nov-14 Core Wall - L48 4 16-Nov-14 19-Nov-14 0 4.00 21-Nov-14 Core Wall - L49 4 20-Nov-14 24-Nov-14 0 5.00 26-Nov-14
  • 124.
    Gain/Loss (Days) Gain/Loss(Days) Gain/Loss (Days) Total Last Period Current Week Weekly Movement DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Planned Actual / Forecast Progress Analysis Core Walls Cycles Core Wall Levels Original Duration Planned Start Date Planned Finish Date Total Float Critical Planned Cycle Actual Finish Date Actual Cycle Forecast Finish Date Core Wall - L50 4 25-Nov-14 29-Nov-14 0 5.00 1-Dec-14 Core Wall - L51 4 30-Nov-14 4-Dec-14 0 5.00 6-Dec-14 Core Wall - L52 4 6-Dec-14 9-Dec-14 0 5.00 11-Dec-14 Core Wall - L53 4 10-Dec-14 14-Dec-14 0 5.00 16-Dec-14 Core Wall - L54 4 15-Dec-14 18-Dec-14 0 4.00 20-Dec-14 Core Wall - L55 4 20-Dec-14 23-Dec-14 0 5.00 25-Dec-14 Core Wall - L56 4 24-Dec-14 28-Dec-14 0 5.00 30-Dec-14 Core Wall - L57 3 29-Dec-14 31-Dec-14 0 3.00 2-Jan-15 Core Wall - L58 3 3-Jan-15 5-Jan-15 0 5.00 7-Jan-15 Core Wall - L59 4 6-Jan-15 10-Jan-15 0 5.00 12-Jan-15 Core Wall - L 60 3 11-Jan-15 13-Jan-15 0 3.00 15-Jan-15 Core Wall - L61 3 14-Jan-15 17-Jan-15 0 4.00 19-Jan-15 Core Wall - L62 6 18-Jan-15 24-Jan-15 0 7.00 26-Jan-15 Core Wall - L63 3 25-Jan-15 27-Jan-15 0 3.00 29-Jan-15 Core Wall - L64 5 28-Jan-15 2-Feb-15 0 6.00 4-Feb-15 Core Wall - L65 5 3-Feb-15 8-Feb-15 0 6.00 10-Feb-15 Core Wall - L66 5 9-Feb-15 14-Feb-15 0 6.00 16-Feb-15 Core Wall - L67 4 15-Feb-15 18-Feb-15 0 4.00 20-Feb-15 Core Wall - L68 4 19-Feb-15 23-Feb-15 0 5.00 25-Feb-15 Core Wall - L69 4 24-Feb-15 28-Feb-15 0 5.00 2-Mar-15 Core Wall - L70 5 1-Mar-15 5-Mar-15 0 5.00 7-Mar-15 Core Wall - L71 4 7-Mar-15 10-Mar-15 0 5.00 12-Mar-15 Core Wall - L72 4 11-Mar-15 15-Mar-15 0 5.00 17-Mar-15 Core Wall - L73 4 16-Mar-15 19-Mar-15 0 4.00 21-Mar-15 Core Wall - L74 4 21-Mar-15 24-Mar-15 0 5.00 26-Mar-15 Core Wall - L75 3 25-Mar-15 28-Mar-15 0 4.00 30-Mar-15 Core Wall - L76 3 29-Mar-15 31-Mar-15 0 3.00 2-Apr-15 Core Wall - L77 3 1-Apr-15 4-Apr-15 0 4.00 6-Apr-15 Core Wall - L78 3 5-Apr-15 7-Apr-15 0 3.00 9-Apr-15 Core Wall - L79 3 8-Apr-15 11-Apr-15 0 4.00 13-Apr-15 Core Wall - Level 80 3 12-Apr-15 14-Apr-15 0 3.00 16-Apr-15 Core Wall - L81 3 15-Apr-15 18-Apr-15 0 4.00 20-Apr-15 Core Wall - L82 3 19-Apr-15 21-Apr-15 0 3.00 23-Apr-15 Core Wall - L83 3 22-Apr-15 25-Apr-15 0 4.00 27-Apr-15 Core Wall - Level 84 4 26-Apr-15 29-Apr-15 0 4.00 1-May-15 Core Wall - Level 85 4 30-Apr-15 4-May-15 0 5.00 6-May-15 Core Wall - Level RF,URF 4 6-May-15 10-May-15 0 6.00 12-May-15 Grand Total 10-May-15 12-May-15 (2.00) (1.00) (1.00) Notes Legend **This Analysis was run using the Target Completion Programme (TCP) - Rev 03. Behind the Planned Cycle Achieved the Planned Cycle Ahead of the Planned Cycle
  • 125.
    Gain/Loss (Days) Gain/Loss(Days) Gain/Loss (Days) Total Last Period Current Week Planned Actual / Forecast Progress Analysis Construction of Horizontals - L06 4 10-Mar-14 11-Mar-14 0 - 4-Mar-14 7.00 7.00 Construction of Horizontals - L07 4 17-Mar-14 20-Mar-14 0 9.00 16-Mar-14 12.00 (3.00) (3.00) Construction of Horizontals - L08 4 24-Mar-14 27-Mar-14 0 7.00 25-Mar-14 9.00 (2.00) (2.00) Weekly Movement DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Slabs Cycles Slab Levels Original Duration Planned Start Date Planned Finish Date Total Float Critical Planned Cycle Actual Finish Date Actual Cycle Forecast Finish Date Construction of Horizontals - L09 4 31-Mar-14 3-Apr-14 0 7.00 3-Apr-14 9.00 (2.00) (2.00) Construction of Horizontals - L10 4 7-Apr-14 10-Apr-14 0 7.00 10-Apr-14 7.00 - - Construction of Horizontals - L11 4 14-Apr-14 17-Apr-14 0 7.00 17-Apr-14 7.00 - - Construction of Horizontals - L12 4 21-Apr-14 24-Apr-14 0 7.00 24-Apr-14 7.00 - - Construction of Horizontals - L13 3 28-Apr-14 30-Apr-14 0 6.00 30-Apr-14 6.00 - - Construction of Horizontals - L14 3 4-May-14 6-May-14 0 6.00 8-May-14 8.00 (2.00) (2.00) Construction of Horizontals - L15 3 10-May-14 12-May-14 0 6.00 15-May-14 7.00 (1.00) (1.00) Construction of Horizontals- L16 3 15-May-14 18-May-14 0 6.00 20-May-14 5.00 1.00 1.00 Construction of Horizontals - L17 3 21-May-14 24-May-14 0 6.00 27-May-14 7.00 (1.00) (1.00) Construction of Horizontals - L18 3 29-May-14 1-Jun-14 0 8.00 3-Jun-14 7.00 1.00 1.00 Construction of Horizontals - L19 3 4-Jun-14 7-Jun-14 0 6.00 9-Jun-14 6.00 - - Construction of Horizontals - L20 3 10-Jun-14 12-Jun-14 0 5.00 14-Jun-14 5.00 - - Construction of Horizontals - L21 3 16-Jun-14 18-Jun-14 0 6.00 21-Jun-14 7.00 (1.00) (1.00) Construction of Horizontals - L22 3 22-Jun-14 24-Jun-14 0 6.00 27-Jun-14 6.00 - - Construction of Horizontals- L23 5 28-Jun-14 2-Jul-14 0 8.00 4-Jul-14 7.00 1.00 1.00 Construction of Horizontals - L24 4 7-Jul-14 10-Jul-14 0 8.00 10-Jul-14 6.00 2.00 2.00 Construction of Horizontals - L25 4 15-Jul-14 19-Jul-14 0 9.00 17-Jul-14 7.00 2.00 2.00 Construction of Horizontals - L26 4 22-Jul-14 26-Jul-14 0 7.00 23-Jul-14 6.00 1.00 1.00 Construction of Horizontals - L27 3 31-Jul-14 3-Aug-14 0 8.00 1-Aug-14 9.00 (1.00) (1.00) Construction of Horizontals - L28 3 6-Aug-14 9-Aug-14 0 6.00 9-Aug-14 8.00 (2.00) (2.00) Construction of Horizontals - L29 3 13-Aug-14 16-Aug-14 0 7.00 14-Aug-14 5.00 2.00 2.00 Construction of Horizontals - L30 (M) 3 20-Aug-14 23-Aug-14 0 7.00 22-Aug-14 8.00 (1.00) (1.00) Construction of Horizontals - L31 4 27-Aug-14 31-Aug-14 0 8.00 31-Aug-14 9.00 (1.00) (1.00) Construction of Horizontals - L32 4 2-Sep-14 6-Sep-14 0 6.00 7-Sep-14 7.00 (1.00) (1.00) Construction of Horizontals - L33 4 8-Sep-14 11-Sep-14 0 5.00 12-Sep-14 5.00 - - Construction of Horizontals - L34 4 13-Sep-14 16-Sep-14 0 5.00 18-Sep-14 6.00 (1.00) (1.00) Construction of Horizontals - L35 4 17-Sep-14 21-Sep-14 0 5.00 24-Sep-14 6.00 (1.00) (1.00) Construction of Horizontals - L36 4 23-Sep-14 27-Sep-14 0 6.00 30-Sep-14 6.00 - - Construction of Horizontals - L37 4 29-Sep-14 2-Oct-14 1 5.00 5-Oct-14 Construction of Horizontals - L38 3 6-Oct-14 8-Oct-14 1 6.00 11-Oct-14 Construction of Horizontals - L39 4 9-Oct-14 13-Oct-14 1 5.00 16-Oct-14 Construction of Horizontals - L40 4 14-Oct-14 18-Oct-14 1 5.00 21-Oct-14 Construction of Horizontals - L41 4 20-Oct-14 23-Oct-14 1 5.00 26-Oct-14 Construction of Horizontals - L42 4 26-Oct-14 29-Oct-14 0 6.00 1-Nov-14 Construction of Horizontals - L43 4 1-Nov-14 4-Nov-14 0 6.00 7-Nov-14 Construction of Horizontals - L44 4 5-Nov-14 9-Nov-14 0 5.00 12-Nov-14 Construction of Horizontals - L45 4 11-Nov-14 15-Nov-14 0 6.00 18-Nov-14 Construction of Horizontals - L46 4 17-Nov-14 20-Nov-14 0 5.00 23-Nov-14 Construction of Horizontals - L47 4 22-Nov-14 25-Nov-14 0 5.00 28-Nov-14 Construction of Horizontals - L48 4 26-Nov-14 30-Nov-14 0 5.00 3-Dec-14 Construction of Horizontals - L49 4 30-Nov-14 4-Dec-14 0 4.00 7-Dec-14
  • 126.
    Gain/Loss (Days) Gain/Loss(Days) Gain/Loss (Days) Total Last Period Current Week Planned Actual / Forecast Progress Analysis Weekly Movement DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Slabs Cycles Slab Levels Original Duration Planned Start Date Planned Finish Date Total Float Critical Planned Cycle Actual Finish Date Actual Cycle Forecast Finish Date Construction of Horizontals - L50 4 6-Dec-14 9-Dec-14 0 5.00 12-Dec-14 Construction of Horizontals - L51 4 10-Dec-14 14-Dec-14 0 5.00 17-Dec-14 Construction of Horizontals - L52 4 15-Dec-14 18-Dec-14 0 4.00 21-Dec-14 Construction of Horizontals - L53 4 20-Dec-14 23-Dec-14 0 5.00 26-Dec-14 Construction of Horizontals - L54 4 23-Dec-14 27-Dec-14 0 4.00 30-Dec-14 Construction of Horizontals - L55 3 29-Dec-14 31-Dec-14 0 4.00 3-Jan-15 Construction of Horizontals - L56 3 4-Jan-15 6-Jan-15 0 6.00 9-Jan-15 Construction of Horizontals - L57 4 6-Jan-15 10-Jan-15 0 4.00 13-Jan-15 Construction of Horizontals - L58 4 11-Jan-15 14-Jan-15 0 4.00 17-Jan-15 Construction of Horizontals - L59 3 15-Jan-15 18-Jan-15 0 4.00 21-Jan-15 Construction of Horizontal - L60 3 20-Jan-15 22-Jan-15 0 4.00 25-Jan-15 Construction of Horizontal - L61 3 24-Jan-15 26-Jan-15 0 4.00 29-Jan-15 Construction of Horizontal - L62 ( M ) 5 29-Jan-15 3-Feb-15 0 8.00 6-Feb-15 Construction of Horizontal - L63 4 8-Feb-15 11-Feb-15 0 8.00 14-Feb-15 Construction of Horizontal - L64 3 12-Feb-15 15-Feb-15 1 4.00 18-Feb-15 Construction of Horizontals - L65 3 17-Feb-15 19-Feb-15 1 4.00 22-Feb-15 Construction of Horizontals - L66 3 22-Feb-15 24-Feb-15 1 5.00 27-Feb-15 Construction of Horizontals - L67 3 25-Feb-15 28-Feb-15 1 4.00 3-Mar-15 Construction of Horizontals - L68 3 2-Mar-15 4-Mar-15 1 4.00 7-Mar-15 Construction of Horizontals - L69 3 7-Mar-15 9-Mar-15 2 5.00 12-Mar-15 Construction of Horizontals - L70 3 10-Mar-15 12-Mar-15 2 3.00 15-Mar-15 Construction of Horizontals - L71 3 14-Mar-15 16-Mar-15 2 4.00 19-Mar-15 Construction of Horizontals - L72 3 18-Mar-15 21-Mar-15 1 5.00 24-Mar-15 Construction of Horizontals - L73 3 23-Mar-15 25-Mar-15 0 4.00 28-Mar-15 Construction of Horizontals - L74 3 26-Mar-15 29-Mar-15 0 4.00 1-Apr-15 Construction of Horizontals - L75 3 30-Mar-15 1-Apr-15 0 3.00 4-Apr-15 Construction of Horizontals - L76 3 2-Apr-15 5-Apr-15 0 4.00 8-Apr-15 Construction of Horizontals - L77 3 6-Apr-15 8-Apr-15 0 3.00 11-Apr-15 Construction of Horizontals - L78 3 9-Apr-15 12-Apr-15 0 4.00 15-Apr-15 Construction of Horizontals - L79 3 13-Apr-15 15-Apr-15 0 3.00 18-Apr-15 Construction of Horizontals - L80 3 18-Apr-15 20-Apr-15 0 5.00 23-Apr-15 Construction of Horizontals - L81 3 21-Apr-15 23-Apr-15 0 3.00 26-Apr-15 Construction of Horizontals - L82 3 25-Apr-15 27-Apr-15 0 4.00 30-Apr-15 Construction of Horizontals - L83 2 29-Apr-15 30-Apr-15 0 3.00 3-May-15 Construction of Horizontals - L84 2 3-May-15 4-May-15 0 4.00 7-May-15 Construction of Horizontals - L85 (M) 4 4-May-15 7-May-15 0 3.00 10-May-15 Construction of Horizontals - L86 2 10-May-15 11-May-15 0 4.00 14-May-15 Construction of Roof Deck Slab L87 1 13-May-15 13-May-15 0 2.00 16-May-15 Construction of Top of Roof Slab-L88 2 13-May-15 14-May-15 0 1.00 17-May-15 Grand Total 14-May-15 17-May-15 (3.00) (2.00) (1.00) Notes Legend **This Analysis was run using the Target Completion Programme (TCP) - Rev 03. Behind the Planned Cycle ** According to TCP-Rev 03, The Target Completion Date for Tower Structure is 14-May-15. Achieved the Planned Cycle Ahead of the Planned Cycle
  • 127.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 4 MEP Progress
  • 128.
    Floor Pipes Support Fixing Inst. of CW Horizontal Pipes CW Pipe Test CW Pipe Final Insulation Ducts Support Fixing Duct Fabric. Instal. of Ducts & Insulation Volume, Fire, Smoke, NR Dampers Fixing Inst. of CW Riser Pipes CW Riser Test Inst. of Ducts Risers Ducts Risers Test Inst. of Fan Coil Units FCU Connection (Duct/Pipe) FCU Drain Pipe Inst. of Valves & Acces. Inst. of Flexible Ducts Access Panels Inst. of Plenum Boxes Inst. of Grilles& Diffusers Kitchen Exhaust Fan Fixing Thermostat Fixing HVAC Work Progress Shaft Works (10%) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina CW Pipes Ducts Final Fix (10%) Works with FC Grids Final Fix Works Prior to False Ceiling Clearence Works with FC Grids (10%) Works Prior to FC Clearence (20%) HL Works Prior to Blocks HL Works Prior to Blocks (50%) Chilled Water Pipes Shaft Works Ducts B5 80% 80% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30% 26% 0% 0% 0% B4 80% 80% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30% 26% 0% 0% 0% B3 80% 80% 0% 0% 50% 50% 50% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59% 26% 0% 0% 0% B2 80% 80% 0% 0% 60% 50% 50% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59% 26% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26% 0% 0% 0% G 0% 0% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 60% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 100% 100% 100% 100% 100% 100% 100% 100% 70% 0% 100% 0% 100% 100% 100% 95% 95% 0% 95% 0% 0% 0% 100% 70% 100% 76% 0% 7th 100% 100% 100% 100% 100% 100% 100% 100% 70% 0% 100% 0% 100% 100% 98% 95% 95% 0% 95% 0% 0% 0% 100% 70% 99% 76% 0% 8th 100% 100% 97% 97% 100% 100% 100% 100% 70% 0% 100% 0% 100% 95% 95% 95% 0% 0% 95% 0% 0% 0% 100% 70% 99% 38% 0% 9th 100% 100% 97% 97% 98% 98% 98% 98% 70% 0% 100% 0% 100% 95% 95% 95% 0% 0% 0% 0% 0% 0% 99% 70% 99% 0% 0% 10th 100% 100% 97% 80% 98% 98% 98% 98% 70% 0% 100% 0% 100% 80% 95% 95% 0% 0% 0% 0% 0% 0% 99% 70% 97% 0% 0% 11th 95% 95% 95% 0% 98% 98% 98% 98% 60% 0% 100% 0% 100% 0% 20% 95% 0% 0% 0% 0% 0% 0% 96% 67% 82% 0% 0% 12th 95% 95% 60% 0% 98% 98% 98% 98% 60% 0% 100% 0% 95% 0% 0% 45% 0% 0% 0% 0% 0% 0% 96% 67% 71% 0% 0% 13th 95% 95% 0% 0% 98% 98% 98% 98% 60% 0% 100% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 67% 67% 0% 0% 14th 95% 95% 95% 0% 98% 98% 98% 98% 60% 0% 100% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 67% 67% 0% 0% 15th 95% 95% 95% 0% 98% 98% 98% 98% 60% 0% 100% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 67% 67% 0% 0% 16th 95% 95% 95% 0% 98% 98% 98% 98% 60% 0% 100% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 67% 67% 0% 0% 17th 95% 95% 95% 0% 98% 98% 98% 98% 60% 0% 100% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 67% 67% 0% 0% 18th 95% 95% 95% 0% 98% 98% 98% 98% 0% 0% 98% 0% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 47% 70% 0% 0% 19th 95% 95% 60% 0% 98% 98% 98% 98% 0% 0% 70% 0% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 34% 70% 0% 0% 20th 95% 95% 0% 0% 98% 98% 98% 98% 0% 0% 70% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 34% 67% 0% 0% 21st 95% 95% 60% 0% 98% 98% 98% 98% 0% 0% 70% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 34% 67% 0% 0% 22nd 95% 95% 0% 0% 98% 98% 98% 98% 0% 0% 30% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 14% 67% 0% 0% 23rd 95% 95% 0% 0% 98% 98% 98% 98% 0% 0% 0% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 67% 0% 0% 24th 95% 95% 60% 0% 95% 95% 90% 80% 0% 0% 0% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 91% 0% 67% 0% 0% 25th 95% 95% 0% 0% 95% 95% 90% 85% 0% 0% 0% 0% 30% 0% 0% 0% 0% 0% 0% 0% 0% 0% 90% 0% 21% 0% 0% 26th 95% 95% 0% 0% 90% 95% 90% 60% 0% 0% 0% 0% 10% 0% 0% 0% 0% 0% 0% 0% 0% 0% 90% 0% 7% 0% 0% 27th 95% 95% 0% 0% 90% 90% 80% 40% 0% 0% 0% 0% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84% 0% 70% 0% 0% 28th 70% 70% 0% 0% 90% 90% 70% 20% 0% 0% 0% 0% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69% 0% 70% 0% 0% 29th 70% 70% 0% 0% 50% 70% 40% 10% 0% 0% 0% 0% 90% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52% 0% 63% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. MEP Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 2:35 PM
  • 129.
    Floor Pipes Support Fixing Inst. of CW Horizontal Pipes CW Pipe Test CW Pipe Final Insulation Ducts Support Fixing Duct Fabric. Instal. of Ducts & Insulation Volume, Fire, Smoke, NR Dampers Fixing Inst. of CW Riser Pipes CW Riser Test Inst. of Ducts Risers Ducts Risers Test Inst. of Fan Coil Units FCU Connection (Duct/Pipe) FCU Drain Pipe Inst. of Valves & Acces. Inst. of Flexible Ducts Access Panels Inst. of Plenum Boxes Inst. of Grilles& Diffusers Kitchen Exhaust Fan Fixing Thermostat Fixing HVAC Work Progress Shaft Works (10%) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina CW Pipes Ducts Final Fix (10%) Works with FC Grids Final Fix Works Prior to False Ceiling Clearence Works with FC Grids (10%) Works Prior to FC Clearence (20%) HL Works Prior to Blocks HL Works Prior to Blocks (50%) Chilled Water Pipes Shaft Works Ducts 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. MEP Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 2:35 PM
  • 130.
    Floor Pipes Support Fixing Inst. of CW Horizontal Pipes CW Pipe Test CW Pipe Final Insulation Ducts Support Fixing Duct Fabric. Instal. of Ducts & Insulation Volume, Fire, Smoke, NR Dampers Fixing Inst. of CW Riser Pipes CW Riser Test Inst. of Ducts Risers Ducts Risers Test Inst. of Fan Coil Units FCU Connection (Duct/Pipe) FCU Drain Pipe Inst. of Valves & Acces. Inst. of Flexible Ducts Access Panels Inst. of Plenum Boxes Inst. of Grilles& Diffusers Kitchen Exhaust Fan Fixing Thermostat Fixing HVAC Work Progress Shaft Works (10%) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina CW Pipes Ducts Final Fix (10%) Works with FC Grids Final Fix Works Prior to False Ceiling Clearence Works with FC Grids (10%) Works Prior to FC Clearence (20%) HL Works Prior to Blocks HL Works Prior to Blocks (50%) Chilled Water Pipes Shaft Works Ducts 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. MEP Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 2:35 PM
  • 131.
    Works Prior toFalse Ceiling Clearence Fire Fighting Work Progress Floor HL Works Prior to Blocks Shaft Work Works with FC Grids Final Fix Pipes Support Fixing Inst. of Fire Fighting Pipes Fire Pipe Test and Flushing Inst. of Riser Pipes Riser Test Installation of Zone Control Valves DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Installation of Sprinkler Dropper Pipes Installation of Identification Labels Installation of Landing Valve Installation of Sprinkler Heads Installation of Sprinkler Cover Installation of Fire Hose Reel and Cabinet Installation of Fire Extinguishers HL Works Prior to Blocks (65%) Works Prior to FC Clearence (5%) Works with FC Grids (10%) Final Fix (10%) Shaft Works (10%) B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B4 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78% 0% 0% 0% 0% B3 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78% 0% 0% 0% 0% B2 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 100% 100% 100% 100% 100% 0% 0% 100% 0% 0% 0% 0% 0% 100% 100% 0% 5% 0% 7th 100% 100% 100% 100% 100% 0% 0% 100% 0% 0% 0% 0% 0% 100% 100% 0% 5% 0% 8th 100% 100% 100% 100% 100% 0% 0% 100% 0% 0% 0% 0% 0% 100% 100% 0% 5% 0% 9th 100% 100% 100% 100% 100% 0% 0% 100% 0% 0% 0% 0% 0% 100% 100% 0% 5% 0% 10th 100% 100% 100% 100% 100% 0% 0% 100% 0% 0% 0% 0% 0% 100% 100% 0% 5% 0% 11th 100% 100% 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 100% 100% 0% 0% 0% 12th 100% 100% 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 100% 100% 0% 0% 0% 13th 100% 100% 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 100% 100% 0% 0% 0% 14th 100% 100% 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 100% 100% 0% 0% 0% 15th 100% 100% 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 100% 100% 0% 0% 0% 16th 100% 100% 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 100% 100% 0% 0% 0% 17th 100% 100% 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 100% 100% 0% 0% 0% 18th 100% 100% 100% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 100% 95% 0% 0% 0% 19th 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 0% 0% 0% 0% 20th 100% 100% 60% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 99% 0% 0% 0% 0% 21st 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 0% 0% 0% 0% 22nd 100% 100% 60% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 99% 0% 0% 0% 0% 23rd 100% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 0% 0% 0% 0% 24th 100% 100% 40% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 99% 0% 0% 0% 0% 25th 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 98% 0% 0% 0% 0% 26th 98% 98% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 0% 0% 0% 0% 27th 98% 98% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 0% 0% 0% 0% 28th 90% 90% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 88% 0% 0% 0% 0% 29th 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. MEP Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 2:35 PM
  • 132.
    Works Prior toFalse Ceiling Clearence Floor Pipes Support Fixing Inst. of Fire Fighting Pipes Fire Pipe Test and Flushing Inst. of Riser Pipes Riser Test Installation of Zone Control Valves Installation of Sprinkler Dropper Pipes Installation of Identification Labels Installation of Landing Valve Installation of Sprinkler Heads Installation of Sprinkler Cover Installation of Fire Hose Reel and Cabinet Installation of Fire Extinguishers HL Works Prior to Blocks (65%) Works Prior to FC Clearence (5%) Works with FC Grids (10%) Final Fix (10%) Shaft Works (10%) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Fire Fighting Work Progress HL Works Prior to Blocks Shaft Work Works with FC Grids Final Fix 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. MEP Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 2:35 PM
  • 133.
    Works Prior toFalse Ceiling Clearence Floor Pipes Support Fixing Inst. of Fire Fighting Pipes Fire Pipe Test and Flushing Inst. of Riser Pipes Riser Test Installation of Zone Control Valves Installation of Sprinkler Dropper Pipes Installation of Identification Labels Installation of Landing Valve Installation of Sprinkler Heads Installation of Sprinkler Cover Installation of Fire Hose Reel and Cabinet Installation of Fire Extinguishers HL Works Prior to Blocks (65%) Works Prior to FC Clearence (5%) Works with FC Grids (10%) Final Fix (10%) Shaft Works (10%) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Fire Fighting Work Progress HL Works Prior to Blocks Shaft Work Works with FC Grids Final Fix 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. MEP Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 2:35 PM
  • 134.
    Floor Drainage Pipes Support Fixing Inst. of Drainage Pipes & Fittings Drainage Pipes Test Water Pipes Support Fixing Inst. of Water Pipes & Fittings Inst. Of Drainage Pipes Riser Drainage Riser Test Inst. Of Water Pipes Riser WS Riser Test Cutting & Chasing in Block Walls Fixing Drainage Pipes in Block Walls Drainage Pipes Test Fixing Water Pipes in Block Water Pipes Test Inst. & Connection to Water Heater Inst. of Identification Labels Inst. of Sanitary ware Inst. of Water Meter Inst. of Floor Drain Covers Plumbing Work Progress HL Works Prior to Blocks Final Fix HL Works Prior to Blocks (60%) Works Prior to FC Clearence (5%) Final Fix (15%) Shaft Works DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Concealed MEP Services (10%) Drainage Water Supply Concealed MEP Services Works Prior to False Ceiling Clearence Shaft Works (10%) Drainage Water Supply Horizontal Horizontal Walls B5 40% 40% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22% 0% 0% 0% 0% B4 40% 40% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22% 0% 0% 0% 0% B3 45% 45% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24% 0% 0% 0% 0% B2 40% 40% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 98% 98% 98% 100% 100% 98% 98% 90% 90% 100% 100% 100% 100% 100% 98% 100% 0% 0% 0% 99% 95% 100% 98% 0% 7th 98% 98% 98% 100% 100% 98% 98% 90% 90% 100% 100% 100% 100% 100% 98% 100% 0% 0% 0% 99% 95% 100% 98% 0% 8th 95% 95% 95% 100% 100% 98% 98% 90% 90% 100% 100% 100% 100% 100% 98% 100% 0% 0% 0% 97% 95% 100% 98% 0% 9th 95% 95% 95% 100% 100% 98% 98% 90% 90% 100% 100% 100% 100% 100% 90% 100% 0% 0% 0% 97% 95% 100% 91% 0% 10th 95% 95% 95% 100% 100% 98% 98% 90% 90% 100% 100% 100% 100% 100% 80% 100% 0% 0% 0% 97% 95% 100% 81% 0% 11th 95% 95% 95% 100% 100% 98% 98% 90% 90% 100% 100% 100% 100% 100% 90% 0% 0% 0% 0% 97% 95% 100% 86% 0% 12th 95% 95% 90% 100% 100% 98% 95% 90% 90% 100% 100% 100% 100% 100% 80% 0% 0% 0% 0% 97% 94% 100% 76% 0% 13th 95% 95% 90% 100% 100% 98% 98% 90% 90% 100% 100% 100% 100% 60% 80% 0% 0% 0% 0% 97% 95% 99% 76% 0% 14th 95% 95% 90% 100% 100% 95% 95% 90% 90% 100% 100% 100% 98% 0% 80% 0% 0% 0% 0% 97% 93% 97% 76% 0% 15th 98% 98% 98% 100% 100% 95% 95% 90% 0% 100% 100% 100% 98% 0% 80% 0% 0% 0% 0% 99% 86% 97% 76% 0% 16th 98% 98% 98% 100% 100% 95% 95% 90% 0% 100% 100% 100% 98% 0% 60% 0% 0% 0% 0% 99% 86% 97% 57% 0% 17th 98% 98% 98% 95% 98% 95% 95% 90% 0% 100% 100% 100% 98% 0% 80% 0% 0% 0% 0% 98% 86% 97% 76% 0% 18th 98% 98% 98% 95% 95% 95% 95% 90% 0% 100% 100% 100% 98% 0% 80% 0% 0% 0% 0% 97% 86% 97% 76% 0% 19th 98% 98% 98% 95% 95% 95% 95% 0% 0% 100% 100% 100% 98% 0% 80% 0% 0% 0% 0% 97% 57% 97% 76% 0% 20th 98% 98% 98% 98% 98% 95% 95% 0% 0% 100% 100% 100% 98% 60% 0% 0% 0% 0% 0% 98% 57% 98% 0% 0% 21st 98% 98% 98% 98% 98% 95% 95% 0% 0% 100% 100% 100% 98% 0% 0% 0% 0% 0% 0% 98% 57% 97% 0% 0% 22nd 98% 98% 98% 90% 90% 95% 95% 0% 0% 100% 98% 98% 98% 0% 0% 0% 0% 0% 0% 95% 57% 96% 0% 0% 23rd 98% 98% 98% 90% 90% 95% 95% 0% 0% 95% 95% 95% 95% 0% 0% 0% 0% 0% 0% 95% 57% 93% 0% 0% 24th 98% 98% 98% 90% 90% 95% 95% 0% 0% 40% 30% 30% 30% 0% 0% 0% 0% 0% 0% 95% 57% 30% 0% 0% 25th 98% 98% 98% 90% 90% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 57% 0% 0% 0% 26th 98% 98% 98% 90% 90% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 57% 0% 0% 0% 27th 98% 98% 98% 90% 90% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 57% 0% 0% 0% 28th 98% 98% 98% 90% 90% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 57% 0% 0% 0% 29th 90% 90% 0% 0% 0% 90% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 43% 0% 0% 0% File: 01. MEP Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 2:35 PM
  • 135.
    Floor Drainage Pipes Support Fixing Inst. of Drainage Pipes & Fittings Drainage Pipes Test Water Pipes Support Fixing Inst. of Water Pipes & Fittings Inst. Of Drainage Pipes Riser Drainage Riser Test Inst. Of Water Pipes Riser WS Riser Test Cutting & Chasing in Block Walls Fixing Drainage Pipes in Block Walls Drainage Pipes Test Fixing Water Pipes in Block Water Pipes Test Inst. & Connection to Water Heater Inst. of Identification Labels Inst. of Sanitary ware Inst. of Water Meter Inst. of Floor Drain Covers Plumbing Work Progress HL Works Prior to Blocks Final Fix HL Works Prior to Blocks (60%) Works Prior to FC Clearence (5%) Final Fix (15%) Shaft Works DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Concealed MEP Services (10%) Drainage Water Supply Concealed MEP Services Works Prior to False Ceiling Clearence Shaft Works (10%) Drainage Water Supply Horizontal Horizontal Walls 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 50% 40% 0% 0% 0% 90% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22% 43% 0% 0% 0% 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. MEP Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 2:35 PM
  • 136.
    Floor Drainage Pipes Support Fixing Inst. of Drainage Pipes & Fittings Drainage Pipes Test Water Pipes Support Fixing Inst. of Water Pipes & Fittings Inst. Of Drainage Pipes Riser Drainage Riser Test Inst. Of Water Pipes Riser WS Riser Test Cutting & Chasing in Block Walls Fixing Drainage Pipes in Block Walls Drainage Pipes Test Fixing Water Pipes in Block Water Pipes Test Inst. & Connection to Water Heater Inst. of Identification Labels Inst. of Sanitary ware Inst. of Water Meter Inst. of Floor Drain Covers Plumbing Work Progress HL Works Prior to Blocks Final Fix HL Works Prior to Blocks (60%) Works Prior to FC Clearence (5%) Final Fix (15%) Shaft Works DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Concealed MEP Services (10%) Drainage Water Supply Concealed MEP Services Works Prior to False Ceiling Clearence Shaft Works (10%) Drainage Water Supply Horizontal Horizontal Walls 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. MEP Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 2:35 PM
  • 137.
    Electrical Work Progress DAMAC Gulf Properties L.L.C HL Works Prior to Blocks (Inside and Below Concrete Slab) Shaft Works Bus B,Light ,Pow. Fire Alarm Voice and Data Emerg. Light Low Current HV Marking & Back Box Inst. of Conduits for Lighting & Power Inst. of Cable Tray / Pulling Wirirng/Cables Marking & Back Box Inst. of Conduits for Fire Alarm Inst. of Cable Tray / Pulling Wirirng/Cables Marking & Back Box Inst. of Conduits for Voice/Data Inst. of Cable Tray / Pulling Wirirng/Cables Marking & Back Box Inst. of Conduits for Emerg. Light Inst. of Cable Tray / Pulling Wirirng/Cables Marking & Back Box Inst. of Conduits for Low Current Inst. of Cable Tray / Pulling Wirirng/Cables Inst. Of Bus Bar Risers Inst. Of Cable Risers Inst. Of Cable Risers Inst. Of Cable Risers Inst. Of Cable Risers Inst. Of HV Cable Light and Power Fire Alarm Voice and Data Emergency Light Low Current (CCTV,Intercom,BMS,Access Control) DAMAC Heights at Dubai Marina Floor Fixing Trunking Fixing Trunking Fixing Trunking Fixing Trunking Fixing Trunking Risers B5 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% B4 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% B3 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% B2 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% B1 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% G 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% P1 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% P2 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% P3 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% P4 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 100% 100% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% P5 95% 95% 0% 0% 95% 95% 0% 0% 95% 95% 0% 0% 95% 95% 0% 0% 95% 95% 40% 40% 0% 0% 0% 0% 0% 0% 6th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 80% 10% 0% 80% 80% 0% 20% 7th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 80% 10% 0% 80% 80% 0% 20% 8th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 80% 10% 0% 80% 80% 0% 20% 9th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 80% 10% 0% 80% 80% 0% 20% 10th 100% 100% 95% 95% 100% 100% 95% 95% 80% 80% 90% 90% 100% 100% 95% 95% 100% 100% 95% 80% 10% 0% 80% 80% 0% 20% 11th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 80% 80% 0% 20% 12th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20% 13th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20% 14th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 90% 95% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20% 15th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 90% 95% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20% 16th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 90% 95% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20% 17th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 90% 70% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20% 18th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 90% 70% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20% 19th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 90% 70% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 20% 20th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 90% 70% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 21st 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 70% 100% 100% 95% 95% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 22nd 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 70% 100% 100% 95% 95% 100% 100% 95% 80% 0% 0% 0% 0% 0% 0% 23rd 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 95% 0% 100% 100% 90% 90% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 24th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 0% 0% 100% 100% 90% 90% 100% 100% 40% 0% 0% 0% 0% 0% 0% 0% 25th 80% 80% 65% 65% 100% 100% 80% 80% 100% 100% 0% 0% 100% 100% 90% 90% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 26th 100% 100% 95% 95% 100% 100% 95% 95% 100% 100% 0% 0% 100% 100% 90% 90% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. MEP Progress as of 30-Sep-14 Page 1 of 6 Printed On: 9/30/2014 at 2:35 PM
  • 138.
    Electrical Work Progress DAMAC Gulf Properties L.L.C HL Works Prior to Blocks (Inside and Below Concrete Slab) Shaft Works Bus B,Light ,Pow. Fire Alarm Voice and Data Emerg. Light Low Current HV Marking & Back Box Inst. of Conduits for Lighting & Power Inst. of Cable Tray / Pulling Wirirng/Cables Marking & Back Box Inst. of Conduits for Fire Alarm Inst. of Cable Tray / Pulling Wirirng/Cables Marking & Back Box Inst. of Conduits for Voice/Data Inst. of Cable Tray / Pulling Wirirng/Cables Marking & Back Box Inst. of Conduits for Emerg. Light Inst. of Cable Tray / Pulling Wirirng/Cables Marking & Back Box Inst. of Conduits for Low Current Inst. of Cable Tray / Pulling Wirirng/Cables Inst. Of Bus Bar Risers Inst. Of Cable Risers Inst. Of Cable Risers Inst. Of Cable Risers Inst. Of Cable Risers Inst. Of HV Cable Light and Power Fire Alarm Voice and Data Emergency Light Low Current (CCTV,Intercom,BMS,Access Control) DAMAC Heights at Dubai Marina Floor Fixing Trunking Fixing Trunking Fixing Trunking Fixing Trunking Fixing Trunking Risers 27th 100% 100% 80% 80% 100% 100% 95% 95% 100% 100% 0% 0% 100% 100% 90% 90% 100% 100% 40% 0% 0% 0% 0% 0% 0% 0% 28th 100% 100% 80% 80% 100% 100% 95% 95% 100% 100% 0% 0% 100% 100% 90% 90% 100% 100% 40% 0% 0% 0% 0% 0% 0% 0% 29th 80% 80% 80% 80% 100% 100% 80% 80% 100% 100% 95% 50% 100% 100% 80% 80% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 30th 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 0% 0% 100% 100% 0% 0% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 31st 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 0% 0% 100% 100% 0% 0% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 32nd 80% 80% 0% 0% 80% 80% 0% 0% 100% 100% 0% 0% 100% 100% 0% 0% 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 34th 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 35th 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 36th 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. MEP Progress as of 30-Sep-14 Page 2 of 6 Printed On: 9/30/2014 at 2:35 PM
  • 139.
    Electrical Work Progress DAMAC Gulf Properties L.L.C HL Works Prior to Blocks (Inside and Below Concrete Slab) Shaft Works Bus B,Light ,Pow. Fire Alarm Voice and Data Emerg. Light Low Current HV Marking & Back Box Inst. of Conduits for Lighting & Power Inst. of Cable Tray / Pulling Wirirng/Cables Marking & Back Box Inst. of Conduits for Fire Alarm Inst. of Cable Tray / Pulling Wirirng/Cables Marking & Back Box Inst. of Conduits for Voice/Data Inst. of Cable Tray / Pulling Wirirng/Cables Marking & Back Box Inst. of Conduits for Emerg. Light Inst. of Cable Tray / Pulling Wirirng/Cables Marking & Back Box Inst. of Conduits for Low Current Inst. of Cable Tray / Pulling Wirirng/Cables Inst. Of Bus Bar Risers Inst. Of Cable Risers Inst. Of Cable Risers Inst. Of Cable Risers Inst. Of Cable Risers Inst. Of HV Cable Light and Power Fire Alarm Voice and Data Emergency Light Low Current (CCTV,Intercom,BMS,Access Control) DAMAC Heights at Dubai Marina Floor Fixing Trunking Fixing Trunking Fixing Trunking Fixing Trunking Fixing Trunking Risers 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. MEP Progress as of 30-Sep-14 Page 3 of 6 Printed On: 9/30/2014 at 2:35 PM
  • 140.
    Emerg. Light GIBox and Conduits Light- Pulling Wirirng/Cables Power - Pulling Wirirng/Cables Fire - Pulling Wirirng/Cables Voice/Data - Pulling Wirirng/Cables Low Curent - Pulling Wirirng/Cables Fire Alarm Devices above Ceiling Power Points Low Current Devices above Ceiling Test of Cables and Test of Cables and installation,Dressing and Termination Inst.of SMDBs Cables Termination Inst.of Tap off unit Inst. of Lights Fixtures Inst. of Powe & Data Installation of Installation of Manual Pull Station Voice Evacuation Installation of Emergency & Exit Inst. of CCTV Inst. of Intercom Inst. of BMS Devices Light and Power Fire Alarm Concealed MEP Services (10%) Works Prior to FC Clearence (10%) Works with FC Grids Final Fix (25%) Low Current (CCTV,Intercom, BMS) Final Fix Works with FC Grids Shaft Works (5%) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina HL Works Prior to Blocks (50%) Electrical Work Progress Concealed MEP Services (Inside Blocks) Works Prior to False Ceiling Clearence Floor B5 B4 B3 B2 B1 G P1 P2 P3 Wires Wires DB Sockets Detectors Lights 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0% P4 P5 6th 7th 8th 9th 10th 11th 12th 13th 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54% 0% 0% 0% 0% 0% 100% 100% 100% 100% 95% 50% 95% 95% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 97% 23% 99% 95% 0% 0% 100% 100% 100% 100% 95% 50% 95% 95% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 97% 23% 99% 95% 0% 0% 100% 100% 100% 100% 95% 100% 95% 95% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 97% 23% 100% 95% 0% 0% 100% 100% 100% 100% 95% 100% 95% 95% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 97% 23% 100% 95% 0% 0% 100% 100% 100% 100% 95% 100% 95% 95% 95% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 23% 100% 95% 0% 0% 100% 100% 100% 100% 95% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 18% 100% 0% 0% 0% 100% 100% 100% 100% 95% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 2% 100% 0% 0% 0% 100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 2% 99% 0% 0% 0% 100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 2% 99% 0% 0% 0% 15th 16th 17th 18th 19th 20th 21st 22nd 23rd 24th 25th 26th 100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 2% 99% 0% 0% 0% 100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 96% 2% 99% 0% 0% 0% 100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 2% 99% 0% 0% 0% 100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 2% 99% 0% 0% 0% 100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 2% 99% 0% 0% 0% 100% 100% 100% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 99% 0% 0% 0% 100% 80% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 96% 0% 0% 0% 100% 80% 80% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 97% 0% 96% 0% 0% 0% 90% 90% 90% 90% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 94% 0% 87% 0% 0% 0% 90% 90% 90% 90% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 94% 0% 87% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 94% 0% 0% 0% 0% 0% File: 01. MEP Progress as of 30-Sep-14 Page 4 of 6 Printed On: 9/30/2014 at 2:35 PM
  • 141.
    Emerg. Light GIBox and Conduits Light- Pulling Wirirng/Cables Power - Pulling Wirirng/Cables Fire - Pulling Wirirng/Cables Voice/Data - Pulling Wirirng/Cables Low Curent - Pulling Wirirng/Cables Fire Alarm Devices above Ceiling Power Points Low Current Devices above Ceiling Test of Cables and Test of Cables and installation,Dressing and Termination Inst.of SMDBs Cables Termination Inst.of Tap off unit Inst. of Lights Fixtures Inst. of Powe & Data Installation of Installation of Manual Pull Station Voice Evacuation Installation of Emergency & Exit Inst. of CCTV Inst. of Intercom Inst. of BMS Devices Light and Power Fire Alarm Concealed MEP Services (10%) Works Prior to FC Clearence (10%) Works with FC Grids Final Fix (25%) Low Current (CCTV,Intercom, BMS) Final Fix Works with FC Grids Shaft Works (5%) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina HL Works Prior to Blocks (50%) Electrical Work Progress Concealed MEP Services (Inside Blocks) Works Prior to False Ceiling Clearence Floor 27th 28th 29th 30th 31st 32nd 33rd 34th Wires Wires DB Sockets Detectors Lights 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 90% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 90% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45% 0% 0% 0% 0% 0% 35th 36th 37th 38th 39th 40th 41st 42nd 43rd 44th 45th 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 48th 49th 50th 51st 52nd 53rd 54th 55th 56th 57th 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. MEP Progress as of 30-Sep-14 Page 5 of 6 Printed On: 9/30/2014 at 2:35 PM
  • 142.
    Emerg. Light GIBox and Conduits Light- Pulling Wirirng/Cables Power - Pulling Wirirng/Cables Fire - Pulling Wirirng/Cables Voice/Data - Pulling Wirirng/Cables Low Curent - Pulling Wirirng/Cables Fire Alarm Devices above Ceiling Power Points Low Current Devices above Ceiling Test of Cables and Test of Cables and installation,Dressing and Termination Inst.of SMDBs Cables Termination Inst.of Tap off unit Inst. of Lights Fixtures Inst. of Powe & Data Installation of Installation of Manual Pull Station Voice Evacuation Installation of Emergency & Exit Inst. of CCTV Inst. of Intercom Inst. of BMS Devices Light and Power Fire Alarm Concealed MEP Services (10%) Works Prior to FC Clearence (10%) Works with FC Grids Final Fix (25%) Low Current (CCTV,Intercom, BMS) Final Fix Works with FC Grids Shaft Works (5%) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina HL Works Prior to Blocks (50%) Electrical Work Progress Concealed MEP Services (Inside Blocks) Works Prior to False Ceiling Clearence Floor 59th 60th 61st 62nd 63rd 64th 65th 66th Wires Wires DB Sockets Detectors Lights 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 68th 69th 70th 71st 72nd 73rd 74th 75th 76th 77th 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 80th 81st 82nd 83rd 84th 85th 86th Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. MEP Progress as of 30-Sep-14 Page 6 of 6 Printed On: 9/30/2014 at 2:35 PM
  • 143.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 5 Finishes Progress
  • 144.
    Architectural Work Progress Floor Block Work Marking,C utting & Chasing Doors Sub frame Fixing Plaster Floor Screed DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Dry Area (Bed Room and Living Room) Wet Area (Kitchen, Bathroom and Balacony) Painting - Primer Painting - Stucco False Ceiling Suspension False Ceiling Tiling / Boardin Painting - 1st Coat Floor Tiles Timber Doors & Ironmongery Wardrobe Final Paint Coat Block Work Marking, Cutting & Chasing Doors Sub frame Fixing Plaster Water proofing Floor Screed Painting - Primer Painting - Stucco Wall Tiles False Ceiling Suspensi on False Ceiling Tiling / Boarding Painting - 1st Coat Floor Tiles Cabinet Carcass Vanity Counters & Tops Kitchen Cabinet Timber Doors & Ironmongery Shower Enclosure Final Paint Coat B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 95% 0% 100% 95% 0% 80% 60% 15% 0% 0% 0% 0% 0% 0% 95% 0% 100% 90% 10% 0% 20% 20% 60% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 7th 95% 0% 100% 95% 0% 80% 60% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 10% 0% 0% 0% 20% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 8th 95% 0% 100% 95% 0% 80% 60% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 10% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 9th 95% 0% 100% 95% 0% 80% 60% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 95% 0% 100% 95% 0% 80% 50% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 95% 0% 100% 95% 0% 80% 40% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 95% 0% 100% 95% 0% 60% 40% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 95% 0% 100% 95% 0% 50% 20% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 95% 0% 100% 95% 0% 50% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 50% 0% 20% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50% 0% 40% 5% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 95% 0% 100% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 95% 0% 100% 15% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 10% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 95% 0% 100% 5% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 100% 5% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 95% 0% 50% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 50% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26th 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 15% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 29th 5% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Finishes Progress as of 30-Sep-14 Page 1 of 4 Printed On: 9/30/2014 at 11:13 AM
  • 145.
    Architectural Work Progress Floor Block Work Marking,C utting & Chasing Doors Sub frame Fixing Plaster Floor Screed Painting - Primer Painting - Stucco False Ceiling Suspension False Ceiling Tiling / Boardin Painting - 1st Coat Floor Tiles DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Timber Doors & Ironmongery Wardrobe Final Paint Coat Block Work Marking, Cutting & Chasing Doors Sub frame Fixing Plaster Water proofing Floor Screed Painting - Primer Painting - Stucco Wall Tiles False Ceiling Suspensi on False Ceiling Tiling / Boarding Painting - 1st Coat Floor Tiles Cabinet Carcass Vanity Counters & Tops Kitchen Cabinet Timber Doors & Ironmongery Shower Enclosure Final Paint Coat Dry Area (Bed Room and Living Room) Wet Area (Kitchen, Bathroom and Balacony) 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Finishes Progress as of 30-Sep-14 Page 2 of 4 Printed On: 9/30/2014 at 11:13 AM
  • 146.
    Floor B5 B4 B3 B2 Architectural Work Progress Marking,Cuttin g & Chasing Doors Sub frame Fixing Plaster Floor Screed Painting - Primer DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Corridors and Service Rooms Stairs Painting - Stucco Floor Tiles Floor Epoxy Wall Tiles False Ceiling Suspension False Ceiling Tiling / Boarding Painting - 1st Coat Steel Doors Final Paint Coat Marking,Cuttin g & Chasing Plaster Floor Screed Painting - Primer Painting - Stucco Floor Epoxy Painting - 1st Coat Final Paint Coat Handrail Fixing 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 G P1 P2 P3 P4 P5 6th 7th 8th 9th 10th 11th 12th 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 95% 0% 80% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 95% 0% 80% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 95% 0% 80% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 95% 0% 60% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 95% 0% 60% 50% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 95% 0% 60% 40% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 95% 0% 50% 20% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 95% 0% 50% 20% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 15th 16th 17th 18th 19th 20th 21st 22nd 23rd 24th 25th 26th 27th 28th 0% 100% 95% 0% 20% 10% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40% 5% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 95% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 70% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 10% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 100% 5% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 29th 30th 31st 32nd 33rd 34th 35th 36th 37th 38th 39th 40th 41st 42nd 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Finishes Progress as of 30-Sep-14 Page 3 of 4 Printed On: 9/30/2014 at 11:13 AM
  • 147.
    Floor 44th 45th 46th 47th Architectural Work Progress Marking,Cuttin g & Chasing Doors Sub frame Fixing Plaster Floor Screed Painting - Primer DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Painting - Stucco Floor Tiles Floor Epoxy Wall Tiles False Ceiling Suspension False Ceiling Tiling / Boarding Painting - 1st Coat Steel Doors Final Paint Coat Marking,Cuttin g & Chasing Plaster Floor Screed Painting - Primer Painting - Stucco Floor Epoxy Painting - 1st Coat Final Paint Coat Handrail Fixing Corridors and Service Rooms Stairs 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 49th 50th 51st 52nd 53rd 54th 55th 56th 57th 58th 59th 60th 61st 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 64th 65th 66th 67th 68th 69th 70th 71st 72nd 73rd 74th 75th 76th 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 79th 80th 81st 82nd 83rd 84th 85th 86th Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Finishes Progress as of 30-Sep-14 Page 4 of 4 Printed On: 9/30/2014 at 11:13 AM
  • 148.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 6 Ext. Facade Progress
  • 149.
    Floor Brackets Aluminium Frame /Profile Aluminum Backpan with Insulation Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Stick Curtain Wall (From Slab to Slab) Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes See Side Cayan Tower Side Stick Curtain Wall Progress Marriot Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side Insulation Insulation Insulation B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 52% 52% 52% 26% 0% 92% 92% 92% 46% 0% 61% 61% 61% 0% 0% 87% 87% 87% 40% 0% 44% 78% 46% 73% 7th 52% 52% 52% 26% 0% 92% 92% 92% 46% 0% 61% 61% 61% 0% 0% 87% 87% 87% 43% 0% 44% 78% 46% 74% 8th 52% 52% 52% 26% 0% 92% 92% 92% 46% 0% 61% 61% 61% 0% 0% 87% 87% 87% 40% 0% 44% 78% 46% 73% 9th 52% 52% 52% 26% 0% 92% 92% 92% 46% 0% 61% 61% 61% 0% 0% 87% 87% 87% 43% 0% 44% 78% 46% 74% 10th 52% 52% 52% 26% 0% 92% 92% 92% 46% 0% 61% 61% 61% 0% 0% 87% 87% 87% 43% 0% 44% 78% 46% 74% 11th 52% 52% 52% 26% 0% 92% 92% 92% 46% 0% 61% 61% 61% 0% 0% 87% 87% 87% 43% 0% 44% 78% 46% 74% 12th 52% 52% 52% 26% 0% 92% 92% 46% 46% 0% 61% 61% 0% 0% 0% 87% 87% 43% 43% 0% 44% 62% 24% 58% 13th 52% 52% 26% 26% 0% 92% 92% 46% 46% 0% 61% 61% 0% 0% 0% 87% 87% 43% 43% 0% 35% 62% 24% 58% 14th 52% 52% 26% 26% 0% 92% 92% 46% 46% 0% 61% 61% 0% 0% 0% 87% 87% 43% 43% 0% 35% 62% 24% 58% 15th 52% 52% 26% 26% 0% 92% 92% 46% 46% 0% 61% 61% 0% 0% 0% 87% 87% 43% 43% 0% 35% 62% 24% 58% 16th 52% 52% 26% 26% 0% 92% 92% 46% 46% 0% 61% 61% 0% 0% 0% 87% 87% 43% 43% 0% 35% 62% 24% 58% 17th 52% 52% 26% 26% 0% 92% 92% 46% 46% 0% 61% 61% 0% 0% 0% 87% 87% 43% 43% 0% 35% 62% 24% 58% 18th 52% 52% 26% 0% 0% 92% 92% 0% 0% 0% 61% 30% 0% 0% 0% 87% 30% 0% 0% 0% 30% 37% 14% 15% 19th 52% 42% 0% 0% 0% 92% 45% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17% 20% 0% 0% 20th 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0% 21st 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0% 22nd 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0% 23rd 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0% 24th 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0% 25th 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0% 26th 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0% 27th 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0% 28th 30% 25% 0% 0% 0% 50% 35% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10% 15% 0% 0% File: Facade Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 3:25 PM
  • 150.
    Floor Brackets Aluminium Frame /Profile Aluminum Backpan with Insulation Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Stick Curtain Wall (From Slab to Slab) Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes See Side Cayan Tower Side Stick Curtain Wall Progress Marriot Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side Insulation Insulation Insulation 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 3:25 PM
  • 151.
    Floor Brackets Aluminium Frame /Profile Aluminum Backpan with Insulation Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Stick Curtain Wall (From Slab to Slab) Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes See Side Cayan Tower Side Stick Curtain Wall Progress Marriot Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side Insulation Insulation Insulation 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 1% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 3:25 PM
  • 152.
    Floor Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Unitized Curtain Wall Progress Unitized Curtain Wall (On the Slab Edge) Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side Insulation Insulation Insulation Insulation B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 4% 4% 4% 4% 7th 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 4% 4% 4% 4% 8th 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 80% 0% 0% 0% 0% 4% 4% 4% 4% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 3:25 PM
  • 153.
    Floor Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Unitized Curtain Wall Progress Unitized Curtain Wall (On the Slab Edge) Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side Insulation Insulation Insulation Insulation 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 3:25 PM
  • 154.
    Floor Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Glass Panels Saelant Finsihes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Unitized Curtain Wall Progress Unitized Curtain Wall (On the Slab Edge) Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side Insulation Insulation Insulation Insulation 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 1% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 3:25 PM
  • 155.
    Floor Brackets ACPfor Drainage Enclosure Glass Partition Saelant Finsihes Brackets ACP for Drainage Enclosure Glass Partition Saelant Finsihes Brackets ACP for Drainage Enclosure Glass Partition Saelant Finsihes Brackets ACP for Drainage Enclosure Glass Partition Saelant Finsihes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Balcony Partition Progress Balcony Partition Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 3:25 PM
  • 156.
    Floor Brackets ACPfor Drainage Enclosure Glass Partition Saelant Finsihes Brackets ACP for Drainage Enclosure Glass Partition Saelant Finsihes Brackets ACP for Drainage Enclosure Glass Partition Saelant Finsihes Brackets ACP for Drainage Enclosure Glass Partition Saelant Finsihes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Balcony Partition Progress Balcony Partition Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 3:25 PM
  • 157.
    Floor Brackets ACPfor Drainage Enclosure Glass Partition Saelant Finsihes Brackets ACP for Drainage Enclosure Glass Partition Saelant Finsihes Brackets ACP for Drainage Enclosure Glass Partition Saelant Finsihes Brackets ACP for Drainage Enclosure Glass Partition Saelant Finsihes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Balcony Partition Progress Balcony Partition Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 1% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 3:25 PM
  • 158.
    Balcony Balustrade Progress Floor Brackets Aluminium DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Balcony Balustrade Handrail Vision Glass Saelant Finsihes Brackets Aluminium Handrail Vision Glass Saelant Finsihes Brackets Aluminium Handrail Vision Glass Saelant Finsihes Brackets Aluminium Handrail Vision Glass Saelant Finsihes Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 26% 0% 0% 0% 44% 0% 0% 0% 25% 0% 0% 0% 40% 0% 0% 0% 1% 2% 1% 2% 7th 26% 0% 0% 0% 44% 0% 0% 0% 25% 0% 0% 0% 40% 0% 0% 0% 1% 2% 1% 2% 8th 26% 0% 0% 0% 44% 0% 0% 0% 25% 0% 0% 0% 40% 0% 0% 0% 1% 2% 1% 2% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 3:25 PM
  • 159.
    Balcony Balustrade Progress Floor Brackets Aluminium DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Balcony Balustrade Handrail Vision Glass Saelant Finsihes Brackets Aluminium Handrail Vision Glass Saelant Finsihes Brackets Aluminium Handrail Vision Glass Saelant Finsihes Brackets Aluminium Handrail Vision Glass Saelant Finsihes Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 3:25 PM
  • 160.
    Balcony Balustrade Progress Floor Brackets Aluminium DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Balcony Balustrade Handrail Vision Glass Saelant Finsihes Brackets Aluminium Handrail Vision Glass Saelant Finsihes Brackets Aluminium Handrail Vision Glass Saelant Finsihes Brackets Aluminium Handrail Vision Glass Saelant Finsihes Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 1% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 3:25 PM
  • 161.
    Floor Brackets Aluminium Frame /Profile Aluminum Backpan with Aluminum Cladding Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Aluminum Cladding Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Aluminum Cladding Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Aluminum Cladding Saelant Finsihes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Balcony Cladding Progress Balcony Cladding (ACP) Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side Insulation Insulation Insulation Insulation B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 3:26 PM
  • 162.
    Floor Brackets Aluminium Frame /Profile Aluminum Backpan with Aluminum Cladding Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Aluminum Cladding Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Aluminum Cladding Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Aluminum Cladding Saelant Finsihes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Balcony Cladding Progress Balcony Cladding (ACP) Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side Insulation Insulation Insulation Insulation 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 3:26 PM
  • 163.
    Floor Brackets Aluminium Frame /Profile Aluminum Backpan with Aluminum Cladding Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Aluminum Cladding Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Aluminum Cladding Saelant Finsihes Brackets Aluminium Frame /Profile Aluminum Backpan with Aluminum Cladding Saelant Finsihes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Balcony Cladding Progress Balcony Cladding (ACP) Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side Insulation Insulation Insulation Insulation 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 1% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 3:26 PM
  • 164.
    Floor Brackets Aluminium Frame/Profile Door Ironmongery Saelant Finsihes Brackets Aluminium Frame/Profile Door Ironmongery Saelant Finsihes Brackets Aluminium Frame/Profile Door Ironmongery Saelant Finsihes Brackets Aluminium Frame/Profile Door Ironmongery Saelant Finsihes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Doors Progress Doors Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 3:25 PM
  • 165.
    Floor Brackets Aluminium Frame/Profile Door Ironmongery Saelant Finsihes Brackets Aluminium Frame/Profile Door Ironmongery Saelant Finsihes Brackets Aluminium Frame/Profile Door Ironmongery Saelant Finsihes Brackets Aluminium Frame/Profile Door Ironmongery Saelant Finsihes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Doors Progress Doors Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 3:25 PM
  • 166.
    Floor Brackets Aluminium Frame/Profile Door Ironmongery Saelant Finsihes Brackets Aluminium Frame/Profile Door Ironmongery Saelant Finsihes Brackets Aluminium Frame/Profile Door Ironmongery Saelant Finsihes Brackets Aluminium Frame/Profile Door Ironmongery Saelant Finsihes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Doors Progress Doors Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 1% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 3:25 PM
  • 167.
    Floor Brackets Aluminium Frame/Profile Louver Tension Rod Saelant Finsihes Brackets Aluminium Frame Louver Tension Rod Saelant Finsihes Brackets Aluminium Frame/Profile Louver Tension Rod Saelant Finsihes Brackets Aluminium Frame Louver Tension Rod Saelant Finsihes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Louvers Progress Louvers Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 3:26 PM
  • 168.
    Floor Brackets Aluminium Frame/Profile Louver Tension Rod Saelant Finsihes Brackets Aluminium Frame Louver Tension Rod Saelant Finsihes Brackets Aluminium Frame/Profile Louver Tension Rod Saelant Finsihes Brackets Aluminium Frame Louver Tension Rod Saelant Finsihes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Louvers Progress Louvers Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 3:26 PM
  • 169.
    Floor Brackets Aluminium Frame/Profile Louver Tension Rod Saelant Finsihes Brackets Aluminium Frame Louver Tension Rod Saelant Finsihes Brackets Aluminium Frame/Profile Louver Tension Rod Saelant Finsihes Brackets Aluminium Frame Louver Tension Rod Saelant Finsihes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Louvers Progress Louvers Marriot Side Cayan Tower Side See Side Marina Side Marriot Side Cayan Tower Side See Side Marina Side 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 87th 1% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Facade Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 3:26 PM
  • 170.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 7 Lifts Progress
  • 171.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem DAMAC Gulf Properties L.L.C Counter Weight Assembl DAMAC Heights at Dubai Marina Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Lift Car Cabin Wiring Final Finishes Lift Machine Room Lift Car Cabin (5%) Lifts Work Progress (Lift - L1) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Shaft (70%) Lift Shaft Lift Entrance Door Rails Rails Platfor bly y Frames Fixing B5 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A 0% 13% 0% N/A 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 5% 0% N/A N/A 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:41 PM
  • 172.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem DAMAC Gulf Properties L.L.C Counter Weight Assembl DAMAC Heights at Dubai Marina Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Lift Car Cabin Wiring Final Finishes Lift Machine Room Lift Car Cabin (5%) Lifts Work Progress (Lift - L1) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Shaft (70%) Lift Shaft Lift Entrance Door Rails Rails Platfor bly y Frames Fixing 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 54th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 55th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 56th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 57th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 0% 0% 0% 0% 0% 0% N/A N/A N/A 0% N/A 58th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 59th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 60th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 61st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 62nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 63rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 64th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 65th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 66th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 67th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:41 PM
  • 173.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem DAMAC Gulf Properties L.L.C Counter Weight Assembl DAMAC Heights at Dubai Marina Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Lift Car Cabin Wiring Final Finishes Lift Machine Room Lift Car Cabin (5%) Lifts Work Progress (Lift - L1) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Shaft (70%) Lift Shaft Lift Entrance Door Rails Rails Platfor bly y Frames Fixing 68th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 69th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 70th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 71st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 72nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 73rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 74th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 75th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 76th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 77th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 78th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 79th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 80th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 81st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 82nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 83rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 84th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 85th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 86th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A Roof N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 1% N/A 1% N/A 1% N/A File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:41 PM
  • 174.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - L2) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing B5 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A 0% 13% 0% N/A 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 5% 0% N/A N/A 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:41 PM
  • 175.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - L2) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 54th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 55th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 56th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 57th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 0% 0% 0% 0% 0% 0% N/A N/A N/A 0% N/A 58th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 59th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 60th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 61st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 62nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 63rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 64th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 65th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 66th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 67th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:41 PM
  • 176.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - L2) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 68th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 69th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 70th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 71st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 72nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 73rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 74th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 75th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 76th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 77th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 78th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 79th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 80th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 81st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 82nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 83rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 84th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 85th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 86th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A Roof N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 1% N/A 1% N/A 1% N/A File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:41 PM
  • 177.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - L3) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing B5 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A 0% 13% 0% N/A 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 5% 0% N/A N/A 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:41 PM
  • 178.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - L3) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% N/A N/A N/A N/A N/A N/A N/A 0% 0% N/A N/A 54th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 55th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 56th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 57th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 0% 0% 0% 0% 0% 0% N/A N/A N/A 0% N/A 58th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 59th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 60th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 61st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 62nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 63rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 64th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 65th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 66th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 67th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:41 PM
  • 179.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - L3) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 68th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 69th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 70th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 71st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 72nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 73rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 74th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 75th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 76th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 77th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 78th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 79th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 80th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 81st N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 82nd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 83rd N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 84th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 85th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 86th N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A Roof N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A N/A 1% N/A 1% N/A 1% N/A File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:41 PM
  • 180.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - L4) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing B5 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 181.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - L4) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 182.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - L4) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1% 1% File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 183.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - L5) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing B5 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 184.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - L5) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 185.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - L5) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1% 1% File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 186.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - L6) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing B5 100% 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 187.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - L6) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 188.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - L6) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1% 1% File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 189.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - M7) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 190.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - M7) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 191.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - M7) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1% 1% 1% File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 192.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - M8) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 193.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - M8) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 194.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - M8) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1% 1% 1% File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 195.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - M9) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 196.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - M9) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 197.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - M9) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1% 1% 1% File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:42 PM
  • 198.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - H10) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:43 PM
  • 199.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - H10) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:43 PM
  • 200.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - H10) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Lift Machine Room (15%) Lift Car Cabin (5%) Rails Rails Platfor bly y Frames Fixing 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1% File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:43 PM
  • 201.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes Lift Machine Room (15%) Lift Car Cabin (5%) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - H11) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Rails Rails Platfor bly y Frames Fixing B5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 100% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 5% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:43 PM
  • 202.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes Lift Machine Room (15%) Lift Car Cabin (5%) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - H11) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Rails Rails Platfor bly y Frames Fixing 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:43 PM
  • 203.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes Lift Machine Room (15%) Lift Car Cabin (5%) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - H11) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Rails Rails Platfor bly y Frames Fixing 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1% File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:43 PM
  • 204.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes Lift Machine Room (15%) Lift Car Cabin (5%) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - H12) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Rails Rails Platfor bly y Frames Fixing B5 20% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 0% B4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% B1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:43 PM
  • 205.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes Lift Machine Room (15%) Lift Car Cabin (5%) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - H12) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Rails Rails Platfor bly y Frames Fixing 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: 01. Lift Progress as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:43 PM
  • 206.
    Floor Prelim. Works(Incl. Scaffolding) Seperator Steel Beams Lift Cabin Bracket Counter Weight Bracket Lift Cabin Guide Counter Weight Guide Lift Cabin Frame & Counter Weight Frame Lift Cabin Assem Counter Weight Assembl Roping Elec. Wiring Shaft Lighting Landing Entrance Door Landing Entrance Door Landing Entrance Door Panels Elec. Wiring Brakes Motor V3F Control System Auto. Leveling Device Auto. Rescue Device Wiring Final Finishes Lift Machine Room (15%) Lift Car Cabin (5%) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Lifts Work Progress (Lift - H12) Lift Shaft Lift Entrance Door Lift Machine Room Lift Car Cabin Lift Shaft (70%) Lift Entr. Door (10%) Rails Rails Platfor bly y Frames Fixing 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 1% File: 01. Lift Progress as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:43 PM
  • 207.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 8 Garbage Chute Progress
  • 208.
    Floor Chute Support Frame Shaft Works Garbage Room in Ground Floor Garbage Chute Tube Water Supply Line for Cleaning Water Supply Line for Fire Fighting Electrical Cables Chute Intake Door Fire Sprilnklers Cleaning Sprilnklers Automatic Brushing Device Flushing Spray Head Wire Mesh Exhaust Fan Chute Covering in Slope Containers Fire Shutter Door Garbage Compactor Panel Installation Top Roof Vent Garbage Room in Typical Floors Room in Ground Floor DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Top Roof Vente Shaft Works Garbage Chute Progress Garbage Room in Typical Floors B5 B4 B3 B2 B1 G 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P1 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P2 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P3 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P4 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% P5 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 6th 100% 100% 100% 100% 100% 0% 0% 0% 100% 0% 7th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 8th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 9th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 10th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 11th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 12th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 13th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 14th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 15th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 16th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 17th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 18th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 19th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 20th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 21st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 22nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 23rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 24th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 25th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 26th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 27th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 28th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 29th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 30th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 31st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Garbage Chute as of 30-Sep-14 Page 1 of 3 Printed On: 9/30/2014 at 12:45 PM
  • 209.
    Floor Chute Support Frame Shaft Works Garbage Room in Ground Floor Garbage Chute Tube Water Supply Line for Cleaning Water Supply Line for Fire Fighting Electrical Cables Chute Intake Door Fire Sprilnklers Cleaning Sprilnklers Automatic Brushing Device Flushing Spray Head Wire Mesh Exhaust Fan Chute Covering in Slope Containers Fire Shutter Door Garbage Compactor Panel Installation Top Roof Vent Garbage Room in Typical Floors Room in Ground Floor DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Top Roof Vente Shaft Works Garbage Chute Progress Garbage Room in Typical Floors 32nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 33rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 34th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 35th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 36th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 37th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 38th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 39th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 40th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 41st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 42nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 43rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 44th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 45th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 46th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 47th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 48th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 49th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 50th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 51st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 52nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 53rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 54th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 55th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 56th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 57th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 58th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 59th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 60th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 61st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 62nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 63rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 64th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 65th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 66th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 67th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 68th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% File: Garbage Chute as of 30-Sep-14 Page 2 of 3 Printed On: 9/30/2014 at 12:45 PM
  • 210.
    Floor Chute Support Frame Shaft Works Garbage Room in Ground Floor Garbage Chute Tube Water Supply Line for Cleaning Water Supply Line for Fire Fighting Electrical Cables Chute Intake Door Fire Sprilnklers Cleaning Sprilnklers Automatic Brushing Device Flushing Spray Head Wire Mesh Exhaust Fan Chute Covering in Slope Containers Fire Shutter Door Garbage Compactor Panel Installation Top Roof Vent Garbage Room in Typical Floors Room in Ground Floor DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Top Roof Vente Shaft Works Garbage Chute Progress Garbage Room in Typical Floors 69th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 70th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 71st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 72nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 73rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 74th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 75th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 76th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 77th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 78th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 79th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 80th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 81st 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 82nd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 83rd 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 84th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 85th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 86th 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% Roof 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 0% 1% 0% 0% 0% 1% File: Garbage Chute as of 30-Sep-14 Page 3 of 3 Printed On: 9/30/2014 at 12:45 PM
  • 211.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 9 Long Lead Items Log
  • 212.
    Long Lead ItemsStatus Planned Actual Planned Actual Planned Expected/ Actual Planned Days Actual Days Origin Method Arrival Custom Planned Expected/ Actual Mechanical HVAC Works 1 FAHU 08.Mai.14 03.Mär.14 25.Mai.14 10.Jun.14 03.Jun.14 22.Jun.14 160 14.Dez.14 15.Dez.14 Behind -1 2 Fans (Pressurization, Parking Extract,etc) Nuaire 14.Jun.14 12.Mär.14 30.Jun.14 01.Jul.14 08.Jul.14 22.Jul.14 160 19.Jän.15 15.Nov.14 Ahead 65 3 Chilled Water Pumps ALLIED 14.Jun.14 05.Mär.14 30.Jun.14 19.Jul.14 08.Jul.14 24.Aug.14 160 19.Jän.15 30.Nov.14 Ahead 50 4 Cooling Tower 18.Dez.14 25.Mai.14 05.Jän.15 07.Aug.14 13.Jän.15 15.Okt.14 160 22.Jul.15 13.Feb.15 Ahead 159 5 Chiller 08.Jun.14 08.Mär.14 24.Jun.14 23.Jul.14 02.Jul.14 21.Jun.14 180 05.Feb.15 15.Mär.15 Behind -38 6 Heat Exchanger (HEX) Faisal jassim 15.Mai.14 02.Feb.14 02.Jun.14 03.Jul.14 10.Jun.14 22.Jul.14 160 21.Dez.14 30.Okt.14 Ahead 52 7 Air Outlet Plumbing 1 Sump Pump 29.Sep.14 29-Jun-14 18.Okt.14 14-Aug-14 27.Okt.14 15.Okt.14 120 18.Mär.15 15.Dez.14 Ahead 93 2 Booster Pump 29.Sep.14 3-Jun-14 18.Okt.14 8-Jul-14 27.Okt.14 15.Okt.14 120 18.Mär.15 3 Transfer Pump 29.Sep.14 3-Jun-14 18.Okt.14 8-Jul-14 27.Okt.14 15.Okt.14 120 18.Mär.15 4 Sewage Pump 29.Sep.14 29-Jun-14 18.Okt.14 14-Aug-14 27.Okt.14 15.Okt.14 120 18.Mär.15 15.Dez.14 Ahead 93 5 GRP Water Tank 4-Jun-14 14-Aug-14 15.Okt.14 Fire Fighting 1 Fire Pump 08.Jun.14 18-May-14 24.Jun.14 5-Jun-14 02.Jul.14 15.Okt.14 180 05.Feb.15 15.Mär.15 Behind -38 2 FM 200 System 07.Okt.14 23.Okt.14 02.Nov.14 180 03.Jun.15 3 Foam Spray System for Generator 14-May-14 8-Jul-14 4 Fire Alarm Devices 11.Mär.14 16-Feb-14 27.Mär.14 4-Jun-14 05.Apr.14 23.Jun.14 150 30.Sep.14 30.Sep.14 Ahead 0 Electrical Electrical 1 Bus Bars 26.Jul.14 05.Mär.14 13.Aug.14 22.Jun.14 21.Aug.14 15.Okt.14 120 14.Jän.15 15.Feb.15 Behind -32 2 Wiring Accessories 12.Nov.14 16.Apr.14 29.Nov.14 02.Jun.14 08.Dez.14 15.Okt.14 100 05.Apr.15 15.Dez.14 Ahead 111 3 LV Panels and Switchgear 25.Jun.14 18.Mär.14 12.Jul.14 21.Jul.14 20.Jul.14 15.Okt.14 120 14.Dez.14 15.Feb.15 Behind -63 4 Generators 02.Aug.14 24.Aug.14 18.Aug.14 16.Sep.14 26.Aug.14 15.Okt.14 180 30.Mär.15 15.Feb.15 Ahead 43 5 LV Cables 6 MV Cables 26.Mai.14 7 UPS Low Current System 1 BMS 12.Nov.14 25.Mai.14 29.Nov.14 08.Sep.14 08.Dez.14 15.Okt.14 120 28.Apr.15 15.Jän.15 Ahead 103 2 FA System Panels 03.Apr.14 16-Feb-14 20.Apr.14 4-Jun-14 28.Apr.14 23.Jun.14 150 27.Okt.14 30.Sep.14 Ahead 27 3 Access Control System 07.Apr.14 21.Aug.14 4 Audio Itercom System 09.Apr.14 25.Sep.14 5 CCTV System 07.Apr.14 21.Aug.14 6 Central Battery System 18.Feb.14 15.Jul.14 7 GSM System Notes: The Forecast Delivery Dates were given by ATC/REMCO. Material Submittal Submittal Approval SHIPMENT Required On Site (Delivery Date) Delay Ahead/ Behind DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Purchase Order Fabrication and Delivery SPECS Supplier/ Period MATERIAL DESCRIPTION Section Subcont. File :- Page 1 of 1 Printed On :- 13.10.2014 at 13:19
  • 213.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 10 Provisional Sum Nomination Log
  • 214.
    DAMAC Gulf PropertiesL.L.C DAMAC Heights at Dubai Marina Items Notes Branded Apartments Sanitary Wares: Bathtub, Wash Basin, WC and Bidets 20.Apr.14 Alamana Building Materials Re-nomination will be done Light Fittings Kitchen Sink and Sink Mixers 30.Apr.14 Teka Kuchentechnik Fit Out Toilet Access: Bidet mixer, Basin Mixer, Shower set, Bath mixer, Hand spray, Toilet paper holder, Towel ring, Towel rail, Soap dish, Robe hook, Bath grip. 01.Jun.14 Paradosso Trading L.L.C Shower Enclosures Non Branded Apartments Sanitary Wares: Bathtub, Wash Basin, WC and Bidets 20.Apr.14 Danube Building Materials Re-nomination will be done Light Fittings 20.Apr.14 Istanbul Electrical Ware Trading Fit Out : Timber Doors Ironmongery Wardrobes Kitchen Cabinets Vanities Mirrors GRC Cornice Shower Enclosures Toilet Access. 03.Apr.14 JC Maclean International Toilet Access: Bidet mixer, Basin Mixer, Bath mixer, Shower set, Hand spray and Toilet paper holder. 01.Jun.14 Shamsi Gen. Trading Kitchen Sink and Sink Mixers 28.Mai.14 Kitchen Sink: United Supplies Materials Sink Mixers: Danube Building Materials Planned (as per TCP-Rev 02) Actual Nominations of PS Items LOI Issuance by DAMAC Contract Signed by ATC LON Issued by DAMAC Contract Signed by Both Parties Nomination Status Contract Signature Status Engieer Instruction ATC Acceptance Sub-Contractors / Suppliers File:- Page1 of 2 Printed On: 08.10.2014 at 13:21
  • 215.
    DAMAC Gulf PropertiesL.L.C DAMAC Heights at Dubai Marina Items Notes Planned (as per TCP-Rev 02) Actual Nominations of PS Items LOI Issuance by DAMAC Contract Signed by ATC LON Issued by DAMAC Contract Signed by Both Parties Nomination Status Contract Signature Status Engieer Instruction ATC Acceptance Sub-Contractors / Suppliers Ground Floor Sanitary Wares: Bathtub, Wash Basin, WC and Bidets 20.Apr.14 Alamana Building Materials Re-nomination will be done Fendi Fit Out (Entrance Lobby ,Corridor, Reception Area, Lift Lobby, Lift Car): Ceiling, Flooring and Walls Light Fittings FF&E Life Style (Podium 5) Sanitary Wares 20.Apr.14 Alamana Building Materials Re-nomination will be done Fit Out: Ceiling, Flooring and Walls Light Fittings FF&E Lockers Steam and Sauna Jacuzzi Acrylic Panel enclosures for Jacuzzi Pool Furniture Hard and Soft Landscaping Package 09.Jun.14 Jobian Concept Swimming Pool Package Public Areas Electromechanical Package 17.Jul.13 REMCO Lifts Package 16.Jän.13 Toshiba BMU Package 17.Nov.13 Danway Façade Aluminum Package 08.Okt.13 ALICO Façade Lighting Package Steel Structure Package 04.Dez.14 15.Dez.14 08.Apr.14 Noterdam Metal Construction Light Fittings for BOH 12.Okt.14 25.Okt.14 24.Mär.14 Istanbul Electrical Ware Trading Light Fittings for Corridors 20.Apr.14 Istanbul Electrical Ware Trading Steel doors for service rooms for Non Branded Apartments floors 25.Aug.14 Qatar Metal Const. Ind LLC Internal and External Signage File:- Page2 of 2 Printed On: 08.10.2014 at 13:21
  • 216.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 11 Building Permit Status
  • 217.
    Building Permit Status Risk Score DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Description Owner Status Ramboll 1 Closed AECOM 2 Closed 3 Low 4 Low 5 Low Thermal insulation approval from DM and ventilation for Chillers: Obtained. 6 Closed 7 Closed Risk Score Breakdown AECOM Closed FIC final approval: Obtained. AECOM Closed Letter of appointment for Notre Dame Steel: It will be submitted when the shop drawings are ready. Condition to cleared prior to commencement of the related work. ATC / Notredam Open Acceptance of the External paving: To be approved prior to Building Completion Certificate application. ATC Open Structural Steel Shop Drawing Approval: Condition to be cleared prior to commencement of the related work above lev el 84. Closed ATC / Notredam Open DCD approval on level P5: (Awaiting RME package). Condition to be cleared prior to casting level 45. Closed DCA NOC for Building height: Obtained 5 4 3 2 1 0 Medium Low Closed Medium Low Closed File :- Page 1 of 1 Printed On :- 08.10.2014 at 13:19
  • 218.
    المباني ߰ إدارة البناء ߰ تراخيص ߰ قسم تعديلت ߰ أعمال ߰ تصريح الصدار ߰ 187558 تاريخ - 34 - التصريح : 1 ߰ رقم المالك : ߰ اسم : المنطقة : ߰ : اسم ߰ الرض ߰ رقم الرخصة : ߰ نوع العمل : ߰ وصف 17/09/2014 داماك الخليج للعقارات - ش.ذ.م.م 3920569 مرسى دبي ترخيص أعمال تعديلت وإضافات بسيطة )استشاري، مقاول( 1-25- إلغاء شرط الدفاع المدني للطابق الخامس من المعاملة رقم 187558 17/09/ الطباعة : 2014 ߰ تاريخ :2 ߰ رقم المبنى الستشاري )ايكوم ميدل ايست ليمتد )فرع دبى رقم 044391001 الرخصة : الهاتف : الفاكس : 044391000 120196 ߰ : الستشاري ߰ القديم : المجموعة الستشارية العالمية المنفذة : ߰ الشركة الرخصة الهاتف : 3404004 3400700 ߰ الفاكس : رقم )ارابتك للنشاءات )ش.ذ.م.م 216599 : 17/09/2014 الثانوي : ߰ المقاول الرخصة : الهاتف : الفاكس : ߰ رقم : التاريخ 201400457848 : اليصال ߰ رقم قيمة قيمة 2014/12/31 00:تأمين المقاول 00:00 : G022940 : ߰ رقم ߰ ߰ اليصال التاريخ ضمان بنكي الرسوم : 325 ߰ : التجديدات : التجديد الرقــــم : التاريخ : تسمية المقاول لعمال المنشآت الحديدية القياسية )قبل بدء العمل( إعتماد مخططات المنشأ الحديدي )قبل بدء العمل( المراجعة بخصوص الرصف الخارجي قبل النجاز )قبل اصدار شهادة النجاز( خاصة : ߰ اشتراطات عامة : ߰ اشتراطات العمل. ߰ بموقع ߰ والسلمة ߰ المن ߰ بقواعد ߰ التام ߰ اللتزام ߰ مع ߰ الترخيص ߰ هذا ߰ مع ߰ المعتمدة ߰ للمخططات ߰߰ طبقا ߰ بالعمل ߰ المذكور ߰ للمقاول ߰ يسمح ߰.1 أشهر. ߰ ستة ߰ عن ߰ تزيد ߰ لمدة ߰ الموقع ߰ في ߰߰ كليا ߰ العمل ߰ توقف ߰ إذا ߰ أو ߰ الصدار ߰ تاريخ ߰ من ߰ أشهر ߰ ستة ߰ خلل ߰ العمل ߰ يبدأ ߰ لم ߰ إذا ߰ الترخيص ߰ 2. يلغى .߰ العمل ߰ من ߰ النتهاء ߰ عند ߰ التأمبن ߰ واسترداد ߰ النجاز ߰ شهادة ߰ واصدار ߰ المفتوحة ߰ المعاملت ߰ اغلق ߰ المقاول ߰ على ߰.3 .߰ الجوار ߰ أو ߰ الممتلكات ߰ أو ߰ الفراد ߰ في ߰ أضرار ߰ أو ߰ إصابات ߰ أي ߰ حدوث ߰ حال ߰ في ߰߰ الطوارئ ߰ قسم ߰ إبلغ ߰ يجب ߰.4 المباني ߰ إدارة ߰ مدير .߰߰ بالبناء ߰ الخاصة ߰ والشتراطات ߰ والقوانين ߰ المحلية ߰ الوامر ߰ إتباع ߰ يجب ߰.5 والجوار. ߰ الموقع ߰ نظافة ߰ على ߰ والمحافظة ߰ العمل ߰ ومخلفات ߰ النقاض ߰ إزالة ߰ المقاول ߰ على ߰.6 دبي. ߰ امارة ߰ في ߰ المفعول ߰ سارية ߰ رخص ߰ لديهم ߰ الفرعيين ߰ المقاولين ߰ كافة ߰ أن ߰ من ߰ التأكد ߰ الرئيسي ߰ والمقاول ߰ الستشاري ߰ على ߰7. .)8004999(߰)2232323(:߰ البلدية ߰ طوارئ ߰ هاتف العالم ߰ حلم ߰ مبانينا ߰:߰ رؤيتنا صفحة 1 من 2 اللكتروني. ߰ للنظام ߰ الرجوع ߰ يرجى ߰ المعتمدة ߰ البناء ߰ وأنظمة ߰ الشروط ߰ كافة ߰ على ߰ للطلع ߰.8 17/09/14 3920569 187558-34-1
  • 219.
    المباني ߰ إدارة البناء ߰ تراخيص ߰ قسم تعديلت ߰ أعمال ߰ تصريح الصدار ߰ 187558 تاريخ - 34 - التصريح : 1 ߰ رقم المالك : ߰ اسم 17/09/2014 : داماك الخليج للعقارات - ش.ذ.م.م 3920569 مرسى دبي المنطقة : ߰ : اسم 17/09/ الطباعة : 2014 ߰ تاريخ الجديد ߰ الرض ߰ رقم الخدمات: ߰ شروط تامدخ ߰ لصتال ߰)߰ ةقفاوم ߰ )تالصتا معتمدة :߰ المهندس ߰ قرار All Etisalat requirements should be provided as per 2013 Etisalat design guideline for fiber to home considering the following conditions:•12U cabinet to be fixed at a height of 40cm to 120cm from finished floor level•MIN Tel box size should be 40x60x12 for residential premises which have more than two bed room •12U size should be 60x60x30 for commercial•42Ucabinet to be provided in Etisalat room with required ODFs and splitters •The 12u cab or MINI Tel should be equipped with the following:oPatch panels suiting the required no of RJ45 socketsoPower socket oAir circulationoVertical cable managementoMini ODFoNote:-The above items should be provided as shown on Etisalat guide lines amendments. •Fiber optic cable should comply with ITU-T G652B and terminated with SC/APC connectors • 2core fib المباني ߰ إدارة ߰ مدير .)8004999(߰)2232323(:߰ البلدية ߰ طوارئ ߰ هاتف العالم ߰ حلم ߰ مبانينا ߰:߰ رؤيتنا صفحة 2 من 2
  • 220.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 12 Technical Review Log
  • 221.
    Technical Review Reports DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Transmission Provisional Sum Report # (FH/DH/R/..) To Ref. Date Category Details Discipline Revision Remarks 0001 Design Review MEP Peer Review Reports MEP 0 DAMAC 0010 03-Mär-14 0002 Handover DAMAC Heights Project Handover Report General 0 DAMAC 0023 03-Mär-14 0003 Design Review DAMAC Heights Design Review Report General 0 DAMAC 0026 03-Mär-14 0004 SH&E AECOM HSE Interim Status Report SH&E 0 DAMAC 0033 10-Mär-14 0005 Factory Visit Low Voltage Switchgear Assembly Electrical 0 DAMAC 0291 24-Apr-14 0006 Tender Analysis Report Metal Doors Package Architectural 0 DAMAC 0332 28-Apr-14 0007 Factory Visit Low Voltage Switchgear Assembly Electrical 1 ATC 0354 29-Apr-14 0008 Technical Report Design Conflicts and Proposed Solutions Architectural 0 DAMAC 0480 15-Mai-14 0009 Factory Visit Assessment of Performance and Quality of Ready mix Beton Structural 0 DAMAC 0513 19-Mai-14 RE 0010 Technical Report Diaphragm Walls Inspection and Recommendation - Ground Voids & Water Seepage Assessment Structural 0 DAMAC 0518 19-Mai-14 0011 Tender Analysis Report Evaluation of Bidders for ID Fit-out and FF&E Works (Fendi GF and P5) Architectural 0 DAMAC 0519 27-Mai-14 0012 Technical Report Material Submit for Façade Lighting - TEO 24 Electrical 0 DAMAC 0555 22-Mai-14 0013 Evaluation Report REMCO Performance MEP 0 DAMAC 0674 09-Jun-14 0014 Design Review MEP Peer Review Reports - Comments Response / Feedback MEP 1 DAMAC 0675 10-Jun-14 R# 0001 0015 Tender Analysis Report Metal Doors Package Architectural 1 DAMAC 0701 11-Jun-14 R# 0006 0016 Snag Report Mock-up Flat Unit 7307 (Ocean Heights) General 0 DAMAC 0743 16-Jun-14 0017 Technical Report Design Conflicts and Proposed Solutions (RFIs) Architectural 0 DAMAC 0782 22-Jun-14 0018 Technical Report Assessment of Slipform System Structural 0 DAMAC 0785 22-Jun-14 0019 Technical Report Service Doors Assessments Architectural 0 DAMAC 0844 30-Jun-14 PE 0020 Technical Report Pressure Grouting Structural 0 DAMAC 0864 07-Jul-14 0021 SH&E Safety Review Report - AECOM CSO Site Visit SH&E 0 Andy Peters - 21-Jul-14 0022 Tender Analysis Report Metal Doors Package (Responsibility Matrix) Architectural 2 DAMAC 1000 24-Jul-14 0023 Technical Report AECOM Review of Basement Cracks Structural 0 DAMAC 1049 11-Aug-14 0024 Tender Analysis Report Evaluation of Bidders for Interior Fit-out Works Package (Fendi Apartments L43-L84) Architectural 0 DAMAC 1107 10-Aug-14 0025 Technical Report Balcony Drain Pipe Enclosure Proposal Architectural 0 DAMAC 1299 03-Sep-14 0026 Technical Report Discrepancies in Kitchen Architectural Layout (Level 26 - Level 42) Architectural 0 DAMAC 1381 16-Sep-14 Ref. File: Page 1 of 2 Printed On:08.10.2014 at 13:38
  • 222.
    Technical Review Reports DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Transmission Provisional Sum Report # (FH/DH/R/..) To Ref. Date Category Details Discipline Revision Remarks Ref. 0027 Technical Report Water Ingress Through Diaphragm Wall Joint - 17 September 2014 Structural 0 DAMAC 1432 23-Sep-14 File: Page 2 of 2 Printed On:08.10.2014 at 13:38
  • 223.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 13 Outstanding RFIs
  • 224.
    Outstanding Request forInformation (RFIs) RFI No. Rev. Discipline Date Raised Description AECOM Reciept Due for Response Current Date No of Days Pending Forwarded to AECOM Reponse 218 1 Structural 18-Aug-14 Grade of Concrete to be used inside lift pit. 18-Aug-14 1-Sep-14 30-Sep-14 -29 Reuben 291 1 Structural 31-Mar-14 Design Parameters & Sequence to Dismantle Section D-D Steel Strutting Members 31-Mar-14 14-Apr-14 30-Sep-14 Reuben / To Ramboll on 10.04.14 via Ramboll Returned - No action from Ramboll 422 1 Architectural 6-Apr-14 Balcony Drain Pipes. 6-Apr-14 20-Apr-14 30-Sep-14 Bassem / Commetns to client 27-May-14 454 1 Structural 31-Mar-14 Struts Removal Phases 31-Mar-14 14-Apr-14 30-Sep-14 -169 Reuben Client to advise 534 1 Architectural 16-Apr-14 Insulation Aluminium Panel Cladding 17-Sep-14 1-Oct-14 30-Sep-14 1 537 2 Architectural 25-Aug-14 Thickness for cabin interior finishes for elevators 26-Aug-14 9-Sep-14 30-Sep-14 -21 Ramon / Haddad 579 2 Architectural 23-Aug-14 Revised Elevation and section for GR to P5 24-Aug-14 7-Sep-14 30-Sep-14 -23 Ramon / Haddad 597 0 Architectural 4-Jun-14 LF-22 Storage Cabinet 4-Jun-14 18-Jun-14 30-Sep-14 Ramon / To Damac on 28-Aug-14 626 1 Architectural 3-Aug-14 Structural steel metal works drawings for mechanical plant room floors 3-Aug-14 17-Aug-14 30-Sep-14 -44 Ramon / Haddad 630 0 Architectural 7-Jul-14 Balcony drain pipes enclosure in elevation building elevations 7-Jul-14 21-Jul-14 30-Sep-14 -71 Ramon / Haddad 636 1 Architectural 3-Aug-14 Slab Edge Drawings not matching with architectural drawings 3-Aug-14 17-Aug-14 30-Sep-14 -44 Reuben / To Ramboll on 25.08.2014 652 0 Architectural 17-Jul-14 Corewall openings at level 30 17-Jul-14 31-Jul-14 30-Sep-14 Haddad 23-Jul-14 666 0 Architectural 3-Aug-14 Door Type WD55 3-Aug-14 17-Aug-14 30-Sep-14 -44 Ramon / Haddad 667 0 Architectural 3-Aug-14 WD51 - Concrete opening unified size 3-Aug-14 17-Aug-14 30-Sep-14 Haddad 18-Aug-14 681 0 Architectural / Structural 13-Aug-14 Clashes between BMU and the Corewall at Axis (E) 16-Aug-14 30-Aug-14 30-Sep-14 -31 Reuben / To Ramboll on 17.08.2014 / 683 0 Structural 14-Aug-14 Level 86 Thickness and SSL 14-Aug-14 28-Aug-14 30-Sep-14 -33 Reuben / To Ramboll on 25.08.2014 684 1 Architectural 27-Aug-14 Steel Support for Curtain Wall at P5 28-Aug-14 11-Sep-14 30-Sep-14 -19 Ramon / Haddad 685 0 Mechanical 16-Aug-14 Exit Light above stair case door 18-Aug-14 1-Sep-14 30-Sep-14 -29 Ramon / Haddad 694 1 Architectural 28-Sep-14 Discrepancies in Bathrooms Architectural Layout ( 31st to 42nd Floors ) 28-Sep-14 12-Oct-14 30-Sep-14 12 Haddad 710 0 Architectural / Mechanical / Electrical 4-Sep-14 DB / ONTB Recessed in concrete wall (to 43rd to 85th Floors) 6-Sep-14 20-Sep-14 30-Sep-14 -10 686 0 Architectural 19-Aug-14 Discrepancy in plans & elevations for Kitchen type K-26 Level 26 to 27 20-Aug-14 3-Sep-14 30-Sep-14 Haddad 6-Sep-14 715 0 Architectural / Structural / Mechanical 6-Sep-14 ID Drawings 8-Sep-14 22-Sep-14 30-Sep-14 -8 Haddad / Raouf / Reuben DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina File:- Page1 of 2 Printed On:12.10.2014 at 07:12
  • 225.
    Outstanding Request forInformation (RFIs) RFI No. Rev. Discipline Date Raised Description AECOM Reciept Due for Response Current Date No of Days Pending Forwarded to AECOM Reponse DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina 721 0 Architectural 8-Sep-14 Required Counter Depth for Microwave Oven 9-Sep-14 23-Sep-14 30-Sep-14 -7 728 0 Architectural / Structural / Mechanical 11-Sep-14 Head Room Clearance at Level 86 11-Sep-14 25-Sep-14 30-Sep-14 -5 724 0 Architectural / Structural / Mechanical 10-Sep-14 FFL and SSL from Levels 80 to 88 13-Sep-14 27-Sep-14 30-Sep-14 -3 730 0 Architectural 14-Sep-14 Gap between Spandrel Glass Curtain Wall and Corewall 15-Sep-14 29-Sep-14 30-Sep-14 -1 Haddad 732 1 Mechanical 21-Sep-14 Requirment of Water Heater & Water Supply at 69th Floor 21-Sep-14 5-Oct-14 30-Sep-14 5 733 0 Architectural 14-Sep-14 Paint Color Finishes - Parking levels and corridor at non-branded floors 15-Sep-14 29-Sep-14 30-Sep-14 -1 RE / letter send to damac 735 0 Architectural / Structural 18-Sep-14 L86 - Slab System BMU - Connection Details 18-Sep-14 2-Oct-14 30-Sep-14 2 To Ramboll 21.09.2014 736 0 Mechanical 21-Sep-14 Parking Drain Location at Podium 2 21-Sep-14 5-Oct-14 30-Sep-14 5 740 0 Mechanical 25-Sep-14 AC Design Drawing for Typical Floors (43rd to 55th floors) 25-Sep-14 9-Oct-14 30-Sep-14 9 739 0 Architectural 25-Sep-14 Block Wal near fire hose cabinet at corridor 2 25-Sep-14 9-Oct-14 30-Sep-14 9 737 0 Architectural 29-Sep-14 Façade Light cabling arrangement for UCW corner panels 29-Sep-14 13-Oct-14 30-Sep-14 13 743 0 Architectural 30-Sep-14 Inaccessible Telephone Room at level 86 30-Sep-14 14-Oct-14 30-Sep-14 14 741 0 Structural 30-Sep-14 Missing lines of RC slanted columns ends at SSL of level 62 30-Sep-14 14-Oct-14 30-Sep-14 14 Legend Under AECOM Review Under Contractor Preparation Overdue (Review) File:- Page2 of 2 Printed On:12.10.2014 at 07:12
  • 226.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 14 Outstanding Shop Drawings
  • 227.
    Outstanding Shop Drawings TR.No. Rev. Drawin g No. Dwg Rev. DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Description Discipline From To Date of Receipt Due for Response Current Date Days Pending Date Returned Action code 0326 05 ATC F07 SD 1087 05 Slab Edges of Level-8 Structural Arabtec Reuben 19-Mar-14 02.Apr.14 30-Sep-14 30.Mar.14 NA 0328 12 ATC F09 SD 1088 05 Slab edges of level 9 Structural Arabtec Reuben 19-Mar-14 02.Apr.14 30-Sep-14 30.Mar.14 NA 0328 12 ATC F10 SD 1089 05 Slab edges of level 10 Structural Arabtec Reuben 19-Mar-14 02.Apr.14 30-Sep-14 30.Mar.14 NA 1399 01 ATC GF SD 1174 1175 01 Ground floor to podium-5 staircase-1 Plans & Sections (Sheets 1 & 2) Structural Arabtec Reuben 7-Apr-14 21.Apr.14 30-Sep-14 24.Apr.14 No status 1400 01 ATC GF SD 1180 01 Ground Floor to Podium-5 Staircase-2 Plan & section (Sheets 1 & 2) Structural Arabtec Reuben 7-Apr-14 21.Apr.14 30-Sep-14 24.Apr.14 No status 1503 04 ATC F08 SD 1185 04 Level 8 - General Arrangement Plan and Sections (Sheet 1 of 2) Structural Arabtec Rueben 13-Mar-14 27.Mär.14 30-Sep-14 30.Mar.14 NA 1503 04 ATC F08 SD 1185 04 Level 8 - General Arrangement Plan and Sections (Sheet 2 of 2) Structural Arabtec Rueben 13-Mar-14 27.Mär.14 30-Sep-14 30.Mar.14 NA 1801 02 S01 P5 SD 2579 02 Wall W-01 reinforcement detail (Zone A1) Lvl +25.550 to Level 6 Structural Arabtec Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 NA 1801 02 S01 P5 SD 2580 02 Wall W-01 reinforcement detail (Zone A1) Lvl +25.550 to Level 6 Structural Arabtec Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 NA 1801 02 S01 P5 SD 2590 02 Wall W-02 & Wing Walls Reinforcement detail (Pouring 2) Lvl +25.550 to Level 6 (sheet 1 of 2) Structural Arabtec Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 NA 1801 02 S01 P5 SD 2591 02 Wall W-02 & Wing Walls Reinforcement detail (Pouring 2) Lvl +25.550 to Level 6 (sheet 2 of 2) Structural Arabtec Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 NA 1801 02 S01 P5 SD 2794 00 Wall (W-2, W-4,W-6, W-8,9) Reinforcement Details Podium-5 to Level-6 (Sheet 5 of 5) Structural Arabtec Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 NA 1808 02 S01 P5 SD 2561 02 Wall (W02, W04, W06, W08 & W09) Reinforcement Details Podium-5 to +25.550 (Sheet 1 of 2) Structural CICON Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 AAN & RR 1808 02 S01 P5 SD 2562 02 Wall (W02, W04, W06, W08 & W09) Reinforcement Details Podium-5 to +25.550 (Sheet 2 of 2) Structural CICON Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 AAN & RR 1808 02 S01 P5 BBS BBS for the above mentioned drawing. Structural CICON Junaid 14-Jan-14 28.Jän.14 30-Sep-14 23.Jan.14 AAN & RR 2007 01 S01 B3 SD 2735 2736 01 Column - Zone B (B3 to U/s B2) Reinforcement Detail PC-25, PC-26, PC-27 & PC-17 (Sheet 1 of 4) Column - Zone B (B3 to U/s B2) Reinforcement Detail PC-23, PC-24, PC-16 & PC-18 (Sheet 2 of 4) Structural CICON Reuben 18-Sep-14 02.Okt.14 30-Sep-14 2 2108 00 ATC GEN SK 623 00 Podium-5 Secondary Slab Structural Arabtec Junaid 16.01.2014 30.Jän.14 30-Sep-14 19.Jan.14 NA 2118 01 S16 PD4 SD 15609 01 Podium-2 Floor Plan voice/Data Layout. Electrical REMCO Zahid 02.02.2014 16.Feb.14 30-Sep-14 5.Feb.14 NA 2118 01 S16 PD7 SD 15612 00 Podium-3 Floor Plan voice/Data Layout. Electrical REMCO Zahid 02.02.2014 16.Feb.14 30-Sep-14 5.Feb.14 NA Fw to 2230 01 S16 B02 SD 15103 01 Basement 2 floor plan lighting layout Electrical REMCO AECOM on 27.02.2014 13.Mär.14 30-Sep-14 18.Mar.14 NA 2230 01 S16 B01 SD 15104 01 Basement 1 floor plan lighting layout Electrical REMCO Fw to AECOM on 27.02.2014 13.Mär.14 30-Sep-14 18.Mar.14 NA 2238 00 S16 F22 SD 16521 00 22nd floor plan water supply layout Mechanical REMCO Basel 02.02.2014 16.Feb.14 30-Sep-14 15.Feb.14 NA 2276 01 S16 F13 SD 15314 01 Level 13th floor plan Emergency and Exit Lighting Layout. Electrical REMCO Zahid 13-Feb-14 27.Feb.14 30-Sep-14 2324 00 S16 F20 SD 16620 00 Typical (20th & 21st Floor Drainage Layout) Mechanical REMCO Basel 13.02.2014 27.Feb.14 30-Sep-14 26.Feb.14 NA 2325 00 S16 F13 SD 15114 00 Level - 13th floor plan lighting layout. Electrical REMCO Zahid 13.02.2014 27.Feb.14 30-Sep-14 19.Feb.14 NA 2395 01 S16 B05 SD 16500 01 Basement-5 Plan Sheet 1 of 2 Water Supply layout (Sheet 1 of 2) Mechanical REMCO Aiman 18.03.2014 01.Apr.14 30-Sep-14 18.Mar.14 NA 2395 01 S16 B05 SD 16500 01 Basement-5 Plan Sheet 1 of 2 Water Supply layout (Sheet 2 of 2) Mechanical REMCO Aiman 18.03.2014 01.Apr.14 30-Sep-14 18.Mar.14 NA 2395 01 S16 B04 SD 16501 01 Basement-4 Plan Water Supply Layout Mechanical REMCO Aiman 18.03.2014 01.Apr.14 30-Sep-14 18.Mar.14 NA 2395 01 S16 B03 SD 16502 01 Basement-3 Plan Water Supply Layout Mechanical REMCO Aiman 18.03.2014 01.Apr.14 30-Sep-14 18.Mar.14 NA 2395 01 S16 B02 SD 16503 01 Basement-2 Plan Water Supply Layout Mechanical REMCO Aiman 18.03.2014 01.Apr.14 30-Sep-14 18.Mar.14 NA 2395 01 S16 B01 SD 16504 01 Basement-1 Plan Water Supply Layout Mechanical REMCO Aiman 18.03.2014 01.Apr.14 30-Sep-14 18.Mar.14 NA 2404 01 ATC F47 SD 1444 01 Slab Edges of Level-48 and coordinates Structural Arabtec Reuben 17-Aug-14 31.Aug.14 30-Sep-14 -30 2405 01 ATC F49 SD 1445 01 Slab Edges of Level-49 Structural Arabtec Reuben 19-Aug-14 02.Sep.14 30-Sep-14 -28 2406 01 ATC F50 SD 1446 01 Slab Edges of Level-50 Structural Arabtec Reuben 19-Aug-14 02.Sep.14 30-Sep-14 -28 2480 01 S01 L10 SD 3204 3205 01 BBS for the above mentioned drawing. Structural CICON Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12 00 ATC B04 DAB 2062,20 70 to 00 Slab Reinforcement details. (Total 23 drawings) - Draft As-built Structural CICON Reuben 23.02.2014 09.Mär.14 30-Sep-14 1.Apr.14 NA 2421 01 ATC F51 F52 SD 1447 1448 01 Slab Edges of Level-51 & 52 Structural Arabtec 28-Aug-14 11.Sep.14 30-Sep-14 -19 10.Sep.14 2433 01 S01 L11 SD 3173 3174 01 Level-11 PT Slab reinforcement details top and bottom (B2 & T1) Sheet 1 to 5 Structural CICON Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12 File: Page 1 of 6 Printed On: 12.10.2014 at 09:33
  • 228.
    Outstanding Shop Drawings TR.No. Rev. Drawin g No. Dwg Rev. Description Discipline From To Date of Receipt Due for Response Current Date Days Pending Date Returned Action code DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina 2434 00 ATC B03 DAB 2050 to 2115 00 Reinforcement drawings (Total 44 drawings) - As-built Structural CICON Reuben 26.02.2014 12.Mär.14 30-Sep-14 2.Apr.14 NA 2451 01 S01 L12 SD 3183 3184 01 Level-12 PT Slab Reinforcement Details Top and Bottom Structural CICON Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12 2452 01 S01 L13 SD 3194 3195 01 Level-13 PT Slab Reinforcement Details Top and Bottom Structural CICON Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12 2501 01 ATC F58 F59 SD 1454 1455 01 Slab Edges of Level 58 and coordinates Slab Edges of Level 59 and coordinates Structural Arabtec Reuben 17-Sep-14 01.Okt.14 30-Sep-14 1 2507 S16 PD1 SD 16006-1 01 Podium 1 - 1 floor plan A/C Ventilatiomn Sections & Details Mechanical REMCO Aiman 17.04.2014 01.Mai.14 30-Sep-14 27.Apr.14 NA 2507 S16 PD1 SD 16006-2 01 Podium 2 - 1 floor plan A/C Ventilatiomn layout Mechanical REMCO Aiman 17.04.2014 01.Mai.14 30-Sep-14 27.Apr.14 NA 2507 02 S16 PD1 SD 16006 02 Podium 1 floor plan A/C Ventilatiomn layout Mechanical REMCO Aiman 08.06.2014 22.Jun.14 30-Sep-14 16.Jun.14 NA 2536 00 S16 F06 SD 16813 00 Level 6th floor plan MEP coordination layout Mechanical REMCO Aiman 12.03.2014 26.Mär.14 30-Sep-14 30.Mar.14 NA 2542 00 S16 F20 SD 15420 00 20th & 21st Foors plan (typical) fire alarm & voice evacuation layout Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 18.Mar.14 NA 2542 00 S16 F22 SD 15421 00 22nd Floor plan fire alarm & voice evacuation layout Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 18.Mar.14 NA 2543 00 S16 B05 SD 15600 00 Basement to 5th floor plan voice & data layout Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 18.Mar.14 NA 2543 00 S16 B04 SD 15601 00 Basement to 4th floor plan voice & data layout Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 18.Mar.14 NA 2543 00 S16 B03 SD 15602 00 Basement to 3th floor plan voice & data layout Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 18.Mar.14 NA 2543 00 S16 B02 SD 15603 00 Basement to 2th floor plan voice & data layout Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 18.Mar.14 NA 2553 00 S16 F14 SD 15115 00 14th & 15th levels lighting plan Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 30.Mar.14 NA 2553 00 S16 F15 SD 15116 00 16th level lighting plan Electrical REMCO Faisal 13.03.2014 27.Mär.14 30-Sep-14 30.Mar.14 NA 2578 01 S16 PD2 SD 16007 01 Podium - 2 Floor Plan HVAC Layout Mechanical REMCO Aiman 04.06.2014 18.Jun.14 30-Sep-14 10.Jun.14 NA 2621 DAB ATC B01 DAB 2180 - 2201 DAB Draft as built drawings for reinforcement details - As-built Structural CICON Reuben 25.03.2014 08.Apr.14 30-Sep-14 2.Apr.14 NA 2621 DAB ATC B01 DAB 2180 - 2201 DAB Draft as built drawings for reinforcement details - As-built Structural CICON Reuben 05.04.2014 19.Apr.14 30-Sep-14 DAB DAB 2456 DAB S01 RFT DAB 2001- 2075 DAB1 Raft Lift Pit pouring - As-built Structural CICON Reuben 01.03.2014 15.Mär.14 30-Sep-14 2.Apr.14 NA 2455 DAB ATC B02 DAB 2116- 2179 DAB Slab Pouring - As-built Structural CICON Reuben 01.03.2014 15.Mär.14 30-Sep-14 2.Apr.14 NA 2434 00 ATC B04 DAB 2062, 2070- DAB Slab & Beam pull out bar reinforcement details - Draft As-built Drawings Structural CICON Reuben 03.04.2014 17.Apr.14 30-Sep-14 DAB DAB 2434 00 ATC B03 DAB 2050- 2115 DAB Wall W-01 Reinforcement Details (pouring 2) Basement 3 - Draft As-built Drawings Structural CICON Reuben 03.04.2014 17.Apr.14 30-Sep-14 DAB DAB 2455 00 ATC B02 DAB 2116- 2179 DAB B2 Slab Pouring - 1 Reinforcement Bottom Layer B1-Draft As-built Drawings Structural CICON Reuben 03.04.2014 17.Apr.14 30-Sep-14 DAB DAB 2456 00 S01 RFT DAB 2001 - 2075 DAB1 Raft Lift pouring - 1- Bottom. Structural CICON Reuben 03.04.2014 17.Apr.14 30-Sep-14 DAB DAB 2709 00 S18 F23 F24 SD 8517 8518 00 23, 24 & 25 Floor Embedment Layout Architectural ALICO Bassem 08.04.2014 22.Apr.14 30-Sep-14 17.Apr.14 NA 2731 DAB S01 P2 DAB 2202 - 2241 DAB Column reinforcement details A1 Part 1 Podium 2-4 Column PC-06,08,09,10,11,07,22, Slab reinforcement details inside corewall Structural CICON Reuben 15.04.2014 29.Apr.14 30-Sep-14 DAB DAB 2747 00 S16 F19 SD 16619 00 19th Floor Drainage Layout Mechanical REMCO Aiman 16.04.2014 30.Apr.14 30-Sep-14 22.Apr.14 NA 2748 01 S16 GFL SD 16005 16073 01 Ground Floor Plan HVAC Layout & Section Details Mechanical REMCO Aiman 17.06.2014 01.Jul.14 30-Sep-14 22.Jun.14 NA 2758 00 S21 ELV SD 5101 5102 00 Façade access system restraint socket elevation @ North East Architectural DANWAY Bassem 17.04.2014 01.Mai.14 30-Sep-14 7.May.14 NA 2785 00 S16 GFL SD 16605 00 Ground Floor Drainage Layout Mechanical REMCO Aiman 21.04.2014 05.Mai.14 30-Sep-14 29.Apr.14 NA 2819 00 S16 GEN SD 17373 00 Fire Alarm, Emergency & Exit Light Installation Electrical REMCO Faisal 28.04.2014 12.Mai.14 30-Sep-14 1.May.14 NA 2903 02 S21 F43 F48 F52 F55 SD 5114 5115 5116 5117 00 Façade access system restraint socket location plan @ 43rd and 46th floor Façade access system restraint socket location plan @ 48th and 49th floor Façade access system restraint socket location plan @ 52nd and 53rd floor Façade access system restraint socket location plan @ 55th and 58th floor Architectural DANWAY Ramon 23.08.2014 06.Sep.14 30-Sep-14 25.Sep.14 NA 2907 01 S01 L21 SD 2895 2896 01 Level 21 - PT slab reinforcement Detials top & bottom 6 sheets Structural CICON Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12 2908 01 S01 L22 SD 2919 2920 01 Level 22 - PT slab reinforcement Detials top & bottom 6 sheets Structural CICON Reuben 30-Sep-14 14.Okt.14 30-Sep-14 14 2911 00 S21 F45 SD 5118 00 Restraint Socket fixing details at transom and floor slab area Structural DANWAY Ramon 13.05.2014 27.Mai.14 30-Sep-14 29.May.14 NA 2915 00 S16 GFL PD5 SD 16705 16710 00 Ground floor & Podium 5 Fire Fighting Layout Mechanical REMCO Aiman 13.05.2014 27.Mai.14 30-Sep-14 19.May.14 NA File: Page 2 of 6 Printed On: 12.10.2014 at 09:33
  • 229.
    Outstanding Shop Drawings TR.No. Rev. Drawin g No. Dwg Rev. Description Discipline From To Date of Receipt Due for Response Current Date Days Pending Date Returned Action code DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina 2942 00 S01 RFT DAB 2142 to 2314 DAB DRAFT AS-BUILT DRAWINGS - raft pouring, slab pouring, corewall horizontal reinforcement, corewall sectional elevation, corewall vertical reinforcement, etc. Structural CICON Reuben 15-May-14 29.Mai.14 30-Sep-14 2983 00 ATC F17 DAB 1038 DAB DRAFT AS-BUILT DRAWINGS - Level 17 slab edges and coordinates Structural Arabtec Reuben 19.05.2014 02.Jun.14 30-Sep-14 22.May.14 NA 2986 00 ATC F16 F17 F18 F19 SD 6082 6099 6100 6101 00 16,17,18 and 19 floors block wall general arrangement plan & sections details) Architectural Arabtec Ramon 19.05.2014 02.Jun.14 30-Sep-14 1.Jun.14 NA 3046 01 S01 L23 SD 2928 2929 01 Level 23 PT Slab reinforcement details top and bottom Sheets 1 to 6 Structural CICON Reuben 30-Sep-14 14.Okt.14 30-Sep-14 14 3057 00 S16 F30 SD 16030 00 Level 30th floor plan HVAC Layout (2 sheets) Mechanical REMCO Aiman 29.05.2014 12.Jun.14 30-Sep-14 5.Jun.14 NA 3066 01 S01 L24 SD 2935 2936 01 Level 24 PT slab reinforcement details top and bottom (B2 & T1) (6 sheets) Structural CICON Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12 3100 00 S16 F30 SD 16670 00 Level 30th Mechanical Floor High Level Drainage Layout Mechanical REMCO Aiman 02.06.2014 16.Jun.14 30-Sep-14 8.Jun.14 NA 3149 00 ATC GEN SD 0633 0635 0636 00 Water tank water proofing details (sheets 1 to 4) Structural Arabtec Reuben 09.06.2014 23.Jun.14 30-Sep-14 12.Jun.14 NA 3204 00 S22 WP SD 5301 00 Waterproofing details for wet area Architectural Procare Ramon 16.06.2014 30.Jun.14 30-Sep-14 7.Jul.14 NA 3254 01 S01 L26 L28 SD 3100 3279 01 Beam Reinforcement Details 26th floor beam (Sheet 1) Beam Reinforcement Details 28th floor beam (Sheet 3) Structural CICON Reuben 30-Sep-14 14.Okt.14 30-Sep-14 14 3267 01 S01 L29 SD 3285 3286 01 29th floor slab and beam pull out bar B2 & T1 Layer sheets 1 to 3 Structural Arabtec Reuben 30-Sep-14 14.Okt.14 30-Sep-14 14 3281 01 S01 L29 SD 3302 3303 01 Level 29 PT Slab reinforcement details top & bottom (B2 & T1) (Sheets 1 to 7) Structural REMCO Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12 3288 01 S16 F77 F80 SD 16753 16755 01 Level 77th to 79th Typical Floor Fire Fighting Layout Level 80th to 84th Typical Floor Fire Fighting Layout Mechanical Arabtec Raouf 10.09.2014 24.Sep.14 30-Sep-14 18.Sep.14 AAN/NA 3305 00 S16 D81 F83 F85 SD 16756 16757 16758 00 81 & 82 Typical Floor fire fighting layout 83 & 84 Typical Floor fire fighting layout 85 floor fire fighting layout Mechanical REMCO Aiman 28.06.2014 12.Jul.14 30-Sep-14 6.Jul.14 NA 3303 01 S16 F53 SD 16938 01 53rd Floor / slab MEP builder works layout Mechanical REMCO Aiman 02.09.2014 16.Sep.14 30-Sep-14 8.Sep.14 NA 3325 00 S16 F64 SD 16045 00 Level 64th to 66th floor plan HVAC Layout Mechanical Arabtec Aiman 30.06.2014 14.Jul.14 30-Sep-14 12.Jul.14 NA 3368 01 S16 F30 SD 16829 16865 16866 16882 01 Level 30th Floor Plan MEP Coordination (High Level) Sheet 1 of 4 Level 30th Floor Plan MEP Coordination (Low Level) Sheet 2 of 4 Level 30th Floor Plan MEP Section & Details Sheet 3 of 4 Level 30th Floor Plan MEP Section & Details Sheet 4 of 4 Mechanical REMCO Raouf 10.09.2014 24.Sep.14 30-Sep-14 13.Sep.14 NA 3414 00 S16 F57 F63 SD 16940 16942 00 57th to 61st Typical floor / slab MEP builder works layout 63rd floor / slab MEP builder works layout 64th to 66th Typical Floor / Mechanical REMCO Aiman 13.07.2014 27.Jul.14 30-Sep-14 21.Jul.14 NA 3418 01 S01 L30 SD 3327 3328 3329 3330 3331 01 Level 30 RC Slab reinforcement details bottom (B1) (B2), top (T1) (T2), additional bar top, trimmer bar, punching shear details Structural CICON Reuben 30-Sep-14 14.Okt.14 30-Sep-14 14 3475 00 S16 B05 F30 F42 F56 SD 16700 16727 16735 16739 00 Basement 5, 42nd, 56th, (57th to 61st Typical) 75th, 86th, roof & upper roof Floor Fire Fighting layout. 30th & 62nd floors mechanical floor fire fighting layout Mechanical REMCO Aiman 19.07.2014 02.Aug.14 30-Sep-14 31.Jul.14 NA 3475 01 S16 F62 SD 16741 01 62nd Mechanical Floor Fire Fighting layout Mechanical REMCO Raouf 10.09.2014 24.Sep.14 30-Sep-14 20.Sep.14 NA 3474 01 S01 F70 F77 SD 16547 16553 01 70th to 76th Typical Floor Plan Water Supply Layout 77th to 79th Typical Floor Plan Water Supply Layout 84th Floor Plan Water Supply Layout Mechanical REMCO Raouf 14.09.2014 28.Sep.14 30-Sep-14 22.Sep.14 AAN NA 3505 00 S16 GR SD 15305 00 Ground floor plan emergency & exit lighting layout Electrical REMCO Faisal 22.07.2014 05.Aug.14 30-Sep-14 9.Aug.14 NA 3495 00 S16 F73 F75 SD 16650 16651 00 73rd, 74th & 75th Floors Drainage Layout Mechanical REMCO Aiman 22.07.2014 05.Aug.14 30-Sep-14 4.Aug.14 NA 3510 01 S03 SSW SD 4011 01 Zone 4 plan & Retaining wall section details Structural Al Shirawi Reuben 22-Sep-14 06.Okt.14 30-Sep-14 6 3537 01 S16 F85 SD 16558 01 85th Floor Plan Water Supply Layout Mechanical REMCO Raouf 23.09.2014 07.Okt.14 30-Sep-14 29.Sep.14 NA 3531 00 S16 F68 F76 SD 16645 16652 00 68th & 76th floor drainage layout Mechanical REMCO Aiman 26.07.2014 09.Aug.14 30-Sep-14 5.Aug.14 NA File: Page 3 of 6 Printed On: 12.10.2014 at 09:33
  • 230.
    Outstanding Shop Drawings TR.No. Rev. Drawin g No. Dwg Rev. Description Discipline From To Date of Receipt Due for Response Current Date Days Pending Date Returned Action code DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina 3553 00 S16 F78 SD 16654 00 78 & 79 Typical Floors draiange layout Mechanical REMCO Aiman 27.07.2014 10.Aug.14 30-Sep-14 7.Aug.14 NA 3559 00 ATC GEN SD 6212 6213 00 Typical floor corridor tiling layout plan (Sheets 1 to 7) Architectural Arabtec Haddad / Ramon 27-Jul-14 10.Aug.14 30-Sep-14 -51 3590 00 S25 F06 F07 SD 19301 19302 00 Drywall partition plan and details level 6 & 7 Drywall typical details (Sheets 1 & 2) Architectural Batimat Haddad 2-Aug-14 16.Aug.14 30-Sep-14 -45 1.Sep.14 3593 ST S01 P4 P2 GF DAB 2423 2424 DAB Podium 4 zaone A1, zone A2 reinforcement details - DRAFT AS-BUILT DRAWINGS Structural CICON Reuben 03.08.2014 17.Aug.14 30-Sep-14 DAB DAB 3592 00 S01 GF P1 P2 DAB 2281 2282 DAB GF, P1, P2 & P4 Slab & Beam pull out bar reinforcement details - DRAFT AS-BUILT DRAWINGS Structural CICON Reuben 03.08.2014 17.Aug.14 30-Sep-14 DAB DAB 3601 00 ATC F09 SD 6170 6171 00 Toilets tiling layout Level 9 Unit 3 (Type 11 & 16) Architectural Arabtec Haddad 3-Aug-14 17.Aug.14 30-Sep-14 -44 3600 00 ATC F11 SD 6222 00 Toilets tiling layout Level 11 Unit 4 (Type 50) Architectural Arabtec Haddad 3-Aug-14 17.Aug.14 30-Sep-14 -44 3604 00 S21 MP86 SEC-A SD 5119 5120 00 Façade acces system machine manuevering layout at 86th floor Architectural Arabtec Haddad 04.08.2014 18.Aug.14 30-Sep-14 24.Sep.14 NA 3612 01 S16 GEN SD 16075 16076 01 Level 31st to 62nd floor Chilled Water Schematic Riser Diagram Sheets 2 to 3 Level 62nd to 88th Floor Chilled Water Schematic Riser Diagram Sheets 3 to 3 Mechanical REMCO Raouf 10-Sep-14 24.Sep.14 30-Sep-14 -6 3611 00 S01 F32 SD 3464 3465 3466 00 Reinforcement Details of Columns TC-01 & TC-02 - 32nd to U/S 34th floor (Sheets 1 to 4) Structural CICON Reuben 5-Aug-14 19.Aug.14 30-Sep-14 -42 3651 00 S25 F08 F09 SD 19303 19304 00 Drywall partition plan and details level 8 & 9 (Sheets 1 & 2) Architectural Batimat Ramon 10-Aug-14 24.Aug.14 30-Sep-14 -37 9.Sep.14 3698 01 S05 B05 SD 4225 4227 01 Zone - B Level B5 retaining wall from Axis (3) to Axis (8) formwork - Anchor layout (Sheet 1 of 2) - Pour 1 - Pour 2 - Pour 3 & 4 Structural Peri Reuben 25.08.2014 08.Sep.14 30-Sep-14 28.Aug.14 NA 3699 00 S25 F06 GEN SD 19013 19092 19093 00 Reflected ceiling plan & details (level 06, Sheet 1 of 2) Architectural Batimat Ramon 16.08.2014 30.Aug.14 30-Sep-14 18.Aug.14 ANN/NA 3732 00 S01 L30 SD 3695 00 Level 30 RC slab foundation reinforcement details plinth & upstand for GRP water tank Structural Arabtec Reuben 20-Aug-14 03.Sep.14 30-Sep-14 -27 3739 00 S01 F40 SD 3659 3660 00 Reinforcement Detail of Wing Wall 1, 3, 5 and 7 and 2, 4, 6, 8 and 9 (Level 40-42) Structural Arabtec Reuben 20-Aug-14 03.Sep.14 30-Sep-14 -27 3736 00 S13 F42 SD 4687 4688 00 Level 42, 43 and 44 tendon profiles Structural Arabtec Reuben 20-Aug-14 03.Sep.14 30-Sep-14 -27 3741 00 S16 F30 SD 17701 17702 00 Level 30 Floor Plan - Floatinf Ref. for MEP Equipment and Foundation with out equipment Mechancal / Electrical Arabtec Ahmed / Auday 20-Aug-14 03.Sep.14 30-Sep-14 -27 3762 01 S02 L44 SD BSS 3700 3701 3702 3703 3704 3705 3706 3707 3708 01 Level 43 PT Slab Reinforecement Details Bottom (B1) Sheet 1 of 10 Level 43 PT Slab Reinforecement Details Top (T2) Sheet 2 of 10 Level 43 PT Slab Reinforecement Details Bottom (B2) Sheet 1 of 10 Level 43 PT Slab Reinforecement Details Top (T1) Sheet 4 of 10 Level 43 PT Slab Reinforecement Details Additional Bar Bottom & Top (T2) Sheet 5 of 10 Level 43 PT Slab Reinforecement Details Trimmer Bar, Axial Lateral Sheet 6 of 10 Level 43 PT Slab Reinforecement Details Punching Shear Links Sheet 7 of 10 Level 43 PT Slab Reinforecement Details Punching Shear Links Sheet 8 of 10 Level 43 PT Slab Reinforecement Details Section 9 of 10 Level 43 PT Slab Reinforecement Details Post Tension Layout 10 of 10 BBS for the above mentioned drawings Structural CICON Reuben 22-Sep-14 06.Okt.14 30-Sep-14 6 0 00 - - - - 00 Typical Section for Micropile and PVC Pipes Structural IGS Reuben 25-Aug-14 08.Sep.14 30-Sep-14 -22 3765 00 S05 B05 SD 4226 4230 00 Zone B - Level B5 retaining wall from Axis (1 - 3) - Anchor layout, Pour 5, 6, 7 and 8) Structural Peri Reuben 25.08.2014 08.Sep.14 30-Sep-14 12.Oct.14 NA 3774 00 S01 L28 SD 3668 3669 00 Staircase 1 Reinforcement Detail Plan 28th Floor to 30th Floor Sheet 1 of 4 Staircase 1 Reinforcement Detail Plan 30th Floor to 31st Floor Sheet 2 of 4 Structural CICON Reuben 28-Aug-14 11.Sep.14 30-Sep-14 -19 3803 00 S05 L32 SD 4234 4235 4236 4237 4238 00 Slab & Beam formwork layout level 32 to 35 (Part 1) PD8/Multiplex with GT24 sheets 1 to 5 Slab & Beam formwork layout level 32 to 35 (Part 2) PD8/Multiplex with GT24 sheets 2 to 5 Slab & Beam formwork layout level 32 to 35 (Part 3) PD8/Multiplex with GT24 sheets 3 to 5 Slab & Beam formwork layout level 32 to 35 (Part 4) PD8/Multiplex with GT24 sheets 4 to 5 Slab & Beam formwork Sections & Details level 32 to 35 (Part 1) PD8/Multiplex with GT24 sheets 1 to 5 Structural PERI LLC Reuben 12-Oct-14 26.Okt.14 30-Sep-14 26 9.Sep.14 File: Page 4 of 6 Printed On: 12.10.2014 at 09:33
  • 231.
    Outstanding Shop Drawings TR.No. Rev. Drawin g No. Dwg Rev. Description Discipline From To Date of Receipt Due for Response Current Date Days Pending Date Returned Action code DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina 3878 00 ATC B04 SD 1605 1606 1607 00 Slab Construction Joint Location for Zone - B from Basement - 4 to Ground Floor (Sheet 1 of 3) Slab Construction Joint Location for Zone - B from Basement - 4 to Ground Floor (Sheet 2 of 3) Slab Construction Joint Location for Zone - B from Basement - 4 to Ground Floor (Sheet 3 of 3) Structural Arabtec Reuben 11.09.2014 25.Sep.14 30-Sep-14 22.Sep.14 NA 3905 00 ATC F11 SD 6273 6274 6275 00 Toilets tiling layout level-11, unit-6 (Type-T17) Toilets tiling layout level-11, unit-6 (Type- T20) Toilets tiling layout level-11, unit-6 (Type-T18) Architectural Arabtec Haddad 15-Sep-14 29.Sep.14 30-Sep-14 -1 3907 00 ATC F11 SD 6314 6315 6316 6317 00 Toilets tiling Layout Level-11, unit-8 Type - 42 Toilets tiling Layout Level-11, unit-8 Type - 1 Toilets tiling Layout Level-11, unit-9 Type - T2 Toilets tiling Layout Level-11, unit-9 Type - 1 Architectural Arabtec Haddad 15-Sep-14 29.Sep.14 30-Sep-14 -1 3912 00 ATC F12 SD 6293 6294 00 Toilets tiling Layout Level-12, Unit-8 (Living & Dining Toilet) Toilets tiling Layout Level-12, Unit-8 (BR- 1Toilet) Architectural Arabtec Haddad 16-Sep-14 30.Sep.14 30-Sep-14 0 3922 00 ATC F09 SD 6231 6232 6233 00 Toilets tiling Layout Level-9, Unit-7 (Type-40) Toilets tiling Layout Level-9, Unit-7 (Type-31) Toilets tiling Layout Level-9, Unit-7 (Type-19) Architectural Arabtec Haddad 16-Sep-14 30.Sep.14 30-Sep-14 0 3936 00 ATC F55 SD 1385 1386 1601 1602 00 Level 55 General Arrangement plan and sections (Sheets 1 to 4) Structural Arabtec Reuben 21-Sep-14 05.Okt.14 30-Sep-14 5 3942 00 S25 F12 F13 F14 F15 SD 19307 19308 19309 19310 00 Drywall partition plan and details (levels 12, 13, 14, 15) & and reference sheets (1 & 2) Architectural Batimat Haddad 21-Sep-14 05.Okt.14 30-Sep-14 5 3941 00 ATC F12 SD 6296 6297 6298 6299 00 Toilets tiling layout level 12 Unit 9 (Type 1) Toilets tiling layout level 12 Unit 9 (Type T2) Toilets tiling layout level 12 Unit 10 (Type 24) Toilets tiling layout level 12 Unit 10 (Type 22) Toilets tiling layout level 12 Unit 10 (Type 23) Architectural Arabtec Haddad 21-Sep-14 05.Okt.14 30-Sep-14 5 3940 00 ATC F56 SD 1387 1388 1608 1609 00 Level 56 General arrangement plan & sections (Sheets 1 to 4) Structural Arabtec Reuben 21-Sep-14 05.Okt.14 30-Sep-14 5 3939 00 ATC F60 SD 1610 00 Slab edges and coordinated level 60 Structural Arabtec Reuben 21-Sep-14 05.Okt.14 30-Sep-14 5 3945 00 ATC F10 F11 SD 6308 6309 6310 6311 00 Toilet tiling layout level 10, Unit 10, Type 24 Toilet tiling layout level 10, Unit 10, Type 23 Toilet tiling layout level 10, Unit 10, Type 22 Toilet tiling layout level 11, Unit 10, Type 24 Toilet tiling layout level 11, Unit 10, Type 23 Toilet tiling layout level 11, Unit 10, Type 22 Structural Arabtec Reuben 22-Sep-14 06.Okt.14 30-Sep-14 6 3951 00 ATC F55 SD 1615 1616 00 Core wall plan and elevation 1 to 9 Level 55 to level 58 -(Sheets 1 to 11) Structural Arabtec Reuben 24-Sep-14 08.Okt.14 30-Sep-14 8 3787 DAB S01 B02 DAB 2149 2156 2157 2158 DAB DRAFT AS-BUILT DRAWINGS - Level Basement 02, Basement 03 Ground, Podium 3, Podium 4, Podium 1, & Podium 2 slab & beam pull out bar reinforcement details Structural Arabtec Reuben 27-Aug-14 10.Sep.14 30-Sep-14 DAB 3959 00 ATC F57 SD 1389 1390 00 Level 57 General Arrangement Plan & Sections (Sheets 1 to 4) Structural Arabtec Reuben 25-Sep-14 09.Okt.14 30-Sep-14 9 3960 00 S16 F41 SD 17346 00 Level 41st floor bedroom & Living Room Ceiling Electrical Co-ordination Layout Electrical REMCO Faisal 25-Sep-14 09.Okt.14 30-Sep-14 9 29.Sep.14 3966 00 ATC F58 SD 1391 1392 00 Level 58 General Arrangement plan & sections (Sheets 1 to 4) Structural Arabtec Reuben 27-Sep-14 11.Okt.14 30-Sep-14 11 3972 00 S01 B02 SD 3763 3764 00 Columns zone B basement 2 to U/S ground floor reinforcement details ( sheets 1 to 3) Structural Arabtec Reuben 28-Sep-14 12.Okt.14 30-Sep-14 12 File: Page 5 of 6 Printed On: 12.10.2014 at 09:33
  • 232.
    Outstanding Shop Drawings TR.No. Rev. Drawin g No. Dwg Rev. Description Discipline From To Date of Receipt Due for Response Current Date Days Pending Date Returned Action code DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina 3976 00 S05 L45 SD 4244 4245 00 Slab & beam formwork layout level 41 to 49 (part 1,2,3,4 &5)PD8 / Multiflex with GT24 (Sheets 1 to 5) Structural PERI LLC Reuben 29-Sep-14 13.Okt.14 30-Sep-14 13 3986 00 S13 F45 F46 SD 4711 4712 00 Levels 45 (Sheets 1 & 2), 46 (Sheets 1 & 2) & 47 (Sheets 1 & 2) Tendon profiles . Structural CCL Reuben 30-Sep-14 14.Okt.14 30-Sep-14 14 3985 00 ATC F59 SD 1393 1394 00 Level 59 General Arrangement Plan & Sections (Sheets 1 to 4) Structural Arabtec Reuben 30-Sep-14 14.Okt.14 30-Sep-14 14 3984 00 ATC F36 SD 6320 00 36th floor block wall general arrangment (plan & sections details) Architectural Arabtec Haddad 30-Sep-14 14.Okt.14 30-Sep-14 14 Legend Under AECOM Review Under Contractor Preparation Overdue (Review) File: Page 6 of 6 Printed On: 12.10.2014 at 09:33
  • 233.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 15 Outstanding Material Submittals
  • 234.
    DAMAC Gulf PropertiesL.L.C Outstanding Material Submittals TR. No. DAMAC Heights at Dubai Marina Rev Description Discipline Contractor / Supplier Forwarded To Sample Date of Receipt Due for Submission Current Date Days Pending Date Returned Action code 2069 2 Motorized Fire & Smoke Dampers Mechanical Safid Aiman / To Damac on No 06.Mär.14 20.Mär.14 30-Sep-14 2.Apr.14 NA 2134 2 Sound Attenuator. Mechanical REMCO Raouf / To DAMAC on No 25.Sep.14 09.Okt.14 30-Sep-14 9 2347 0 Backup Rod Architectural ALICO Arkan No 16.Feb.14 02.Mär.14 30-Sep-14 23.Feb.14 2342 0 Fire Alarm System (Value Engineering) Electrical REMCO Zahid Yes 16.Feb.14 02.Mär.14 30-Sep-14 25.Feb.14 NA 2617 0 Tile Grout Architectural Sodamco Bassem Yes 25.Mär.14 08.Apr.14 30-Sep-14 20.Apr.14 NA 2788 0 Extruded Polystyrene Rigid Insulation (Esscofoam) (35-38 Kg) m3 Structural Teejan General Trading LLC Reuben Yes 21.Apr.14 05.Mai.14 30-Sep-14 10.May.14 NA 2817 0 Material Submittal for Separol FP 15 - Oil based, anti corrosive shutter release agent Structural Sika Reuben / To DAMAC on 06.05.2014 / Yes 27.Apr.14 11.Mai.14 30-Sep-14 12.May.14 NA 2831 2 Material Sample for RAL Colour for emergency exit doors for lifts in match with the color of painted wall: 1. Sample from JOTUN brand. Architectural Toshiba Ramon / Haddad To Damac on 07.08.2014 / Yes 22.Jul.14 05.Aug.14 30-Sep-14 12.Aug.14 NA 2932 2 Foam system (Generator room) Value engineering Mechanical Juma Al Majid Raouf / To Damac on 29.09.2014 No 25.Sep.14 09.Okt.14 30-Sep-14 9 2975 1 Fire Pump Set (Value Engineering) Mechanical REMCO Raouf / To Damac on 29.09.2014 No 28.Sep.14 12.Okt.14 30-Sep-14 12 3012 2 Black Nero Marquina - 20mm thick polished (Marble) Architectural JC Maclean Haddad / To Damac on 24.09.2014 Yes 25.Aug.14 08.Sep.14 30-Sep-14 -22 3017 2 Beech solidwood and 44mm Thick NFR KINGSA Door Core in White Matt PU Paint Finish Architectural JC Maclean Haddad / To DAMAC on 10.09.2014 / From DAMAC Yes 21.Aug.14 04.Sep.14 30-Sep-14 16.Sep.14 NA 3016 2 Beech solidwood and 54mm Thick FR HALSPAN Door Core in White Matt PU Paint Finish Architectural JC Maclean Haddad / To DAMAC on 10.09.2014 / Yes 21.Aug.14 04.Sep.14 30-Sep-14 16.Sep.14 NA 3026 2 Cooling Tower (Reply to Consultant Comments) Mechanical REMCO Raouf / To Damac on 08.09.2014 No 02.Sep.14 16.Sep.14 30-Sep-14 -14 3029 0 Aggregates (Crushed) 5mm Interlocking sand & 10 to 20mm Structural Dubai Al Ahlia Transport. Reuben No 25.Mai.14 08.Jun.14 30-Sep-14 Cancelled 3039 0 MV Cables Electrical Al Jalal Trading / Ducab Faisal / To Damac on 01.06.2014 / Yes 26.Mai.14 09.Jun.14 30-Sep-14 4.Jun.14 NA File: Page 1 of 3 Printed On: 12.10.2014 at 07:43
  • 235.
    Outstanding Material Submittals TR. No. Rev Description Discipline Contractor / Supplier Forwarded To Sample Date of Receipt Due for Submission Current Date Days Pending Date Returned Action code DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina 3028 0 Aggregates (Crushed) 5mm Interlocking sand & 10 to 20mm Structural New Generation Gen.Land Tpt. Co Reuben No 26.Mai.14 09.Jun.14 30-Sep-14 Cancelled 3037 2 NAFS125 Clean Agent System (Value Engineering) Mechanical Al Arabia/ Juma Al Majid Raouf / To Damac on 24.08.14 / From Damac No 20.Aug.14 03.Sep.14 30-Sep-14 8.Sep.14 NA 3147 2 Control & Instrumentation Cables Electrical REMCO Faisal / To Damac on 28.09.2014 Yes 25.Sep.14 09.Okt.14 30-Sep-14 9 3161 1 False Ceiling and Drywall Partitions Architectural Batimat Haddad / To DAMAC on 31.08.2014 / From DAMAC Yes 31.Jul.14 14.Aug.14 30-Sep-14 -47 3228 1 Grade B 500B Steel Reinforcement Bar (Deforemed) to be used in production of wheel Structural Arabtec Precast LLC Reuben / No 14.Sep.14 28.Sep.14 30-Sep-14 -2 3390 1 Cat Ladder at roof, lift pit and water tank Architectural WMS Haddad Yes 25.Aug.14 08.Sep.14 30-Sep-14 24.Sep.14 NA 3446 0 4mm thick stone-look ALUPEX -FR cladding for podium façade Architectural ALICO Ramon / Haddad / To Damac on No 16.Jul.14 30.Jul.14 30-Sep-14 16.Sep.14 NA 3479 3 Paint System No.1 1 Coat Kem Epoxy Primer Sealer 1 Coat Tile Clad Spray Texture Hi Build Part A Architectural Sherwin Williams Haddad Yes 27.Sep.14 11.Okt.14 30-Sep-14 11 3551 1 Material Submittal for 250mm wide removal painted steel grating at trenches Architectural Arabtec Haddad / To Damac on 25.09.2014 / Yes 25.Aug.14 08.Sep.14 30-Sep-14 28.Sep.14 NA 3688 0 Material submittal for non-fore rated sealant (Alternative Supplier) Architectural Arabtec Ramon No 14.Aug.14 28.Aug.14 30-Sep-14 7.Sep.14 NA 3689 1 Dynamic Balancing Valve (Value Engineering) Mechanical REMCO Raouf / To Damac on 30.09.2014 No 25.Sep.14 09.Okt.14 30-Sep-14 9 3692 0 Sanitary Ware and stainless steel kitchensink Mechanical Milano Raouf / To DAMAC on 18.08.2014 Yes 16.Aug.14 30.Aug.14 30-Sep-14 -31 3705 0 GL-5: Tempered Sandblasted Glass - 10mm Thick Architectural JC Maclean Haddad / To DAMAC on 10.09.2014 / Yes 18.Aug.14 01.Sep.14 30-Sep-14 16.Sep.14 NA File: Page 2 of 3 Printed On: 12.10.2014 at 07:43
  • 236.
    Outstanding Material Submittals TR. No. Rev Description Discipline Contractor / Supplier Forwarded To Sample Date of Receipt Due for Submission Current Date Days Pending Date Returned Action code DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina 3854 1 Light Fittings for Back of House (BOH) Areas - Submitted for (D1) color approval Mechanical / Electrical Arabtec Raouf / To Damac on 28.09.2014 Yes 25.Sep.14 09.Okt.14 30-Sep-14 9 3871 1 Transfer of Water Supply Riser Support System Mechanical Arabtec Raouf / To Damac on 30.09.2014 Yes 27.Sep.14 11.Okt.14 30-Sep-14 11 3930 0 Chilled, Condenser Water Treatment & Side Stream Filtration System Mechanical Remco Raouf Yes 18.Sep.14 02.Okt.14 30-Sep-14 23.Sep.14 NA 3931 0 GRP Pipes & Fittings (200mm Water Transfer Line) Mechanical Remco Raouf / To Damac on 24.09.2014 / Yes 20.Sep.14 04.Okt.14 30-Sep-14 30.Sep.14 NA 3957 0 1.Pyroplex UK - Timber Fire Door Seals Tripple Flipper 2.Pyroplex UK - Timber Fire Door Seals for 30 and 60 minutes- Architectural JC Maclean Haddad Yes 25.Sep.14 09.Okt.14 30-Sep-14 9 3955 0 Black Absolute Marble Architectural JC Maclean Haddad Yes 25.Sep.14 09.Okt.14 30-Sep-14 9 3956 0 1. Mirror Stainless Steel - Color Silver 2 & 3. Brushed Stainless Steel - Color : Silver Architectural JC Maclean Haddad Yes 25.Sep.14 09.Okt.14 30-Sep-14 9 3962 0 Joinery Accessories: 1. Full Overlay Hinges 2. Half Overlay Hinges Architectural JC Maclean Haddad Yes 25.Sep.14 09.Okt.14 30-Sep-14 9 3969 0 FCU's Acoustic Study (Level 6th to mLevel 42nd) Mechanical REMCO Raouf / To Damac on 30.09.2014 No 28.Sep.14 12.Okt.14 30-Sep-14 12 3971 0 Stainless Steel Strip (To be used between marble and porcelain tiles) Architectural Arabtec Haddad Yes 28.Sep.14 12.Okt.14 30-Sep-14 12 Legend Under AECOM Review Under Contractor Preparation Overdue (Review) File: Page 3 of 3 Printed On: 12.10.2014 at 07:43
  • 237.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 16 Outstanding Pre-qualifications
  • 238.
    Outstadning Pre-Qualification Submittals 2546 0 Sub contractor approval - Prequalification documents pf PT ddesign & Inspection (m/s. CCL Engineering) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Structural ATC/CCL 13-Mar-14 27.Mär.14 30-Sep-14 16-Mar-14 NA Legend Under AECOM Review Under Contractor Preparation Overdue (Review) Days Pending Date Returned Action code Forwarded To Date of Receipt Due for Submission Current Date TR. No. Rev. Description Discipline Contractor/ Subcontractor/ Supplier File:- Page 1 of 1 Printed On: 12.10.2014 at 07:17
  • 239.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 17 Outstanding Method Statements
  • 240.
    Outstanding Method Statements TR.No. Rev. Description Discipline Contractor / Supplier To Date of Receipt Due for Submission Current Date Days Pending Date Returned Action code 2273 0 Method Statement for Bitumen Protective Coating Application. Architecutural Arabtec Arkan 06.Feb.14 20.Feb.14 30-Sep-14 11.Feb.14 AAN & RR 2312 2 Method Statement for installation of Structured Cabling System Electrical REMCO Faisal 08.Apr.14 22.Apr.14 30-Sep-14 20.Apr.14 NA 2328 0 Method Statement for installation of plate heat exchangers Mechanical REMCO Basel 13.Feb.14 27.Feb.14 30-Sep-14 26.Feb.14 NA 2510 1 Method Statement for Installation of Cooling Towers Mechanical REMCO Aiman 21.Sep.14 05.Okt.14 30-Sep-14 23.Sep.14 NA 3386 1 Method statement for fabrication, erection and installation of roof steel structure Structural Arabtec Reuben 28.Aug.14 11.Sep.14 30-Sep-14 06.Aug.14 NA 3388 1 Method statement for dismantling and re-erection of tower crane TC # 2 Structural Arabtec Reuben 21.Sep.14 05.Okt.14 30-Sep-14 5 3751 0 Method Statement for Installation of BMU Systems Structural Danway Reuben 21.Aug.14 04.Sep.14 30-Sep-14 02.Sep.14 NA Legend Under AECOM Review Under Contractor Preparation Overdue (Review) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina File: Page 1 of 1 Printed On: 12.10.2014 at 06:33
  • 241.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 18 NCRs Report
  • 242.
    DAMAC Gulf PropertiesL.L.C Non-Conformance Report Register DAMAC Heights at Dubai Marina NCR No. ATC Replied Date AECOM Response Date 009 Pile Head Repair. GCI ZETAS 20-Oct-12 071 Defects on level 12 AECOM ATC 19-May-14 9-Sep-14 074 Defects on Level 16 AECOM ATC 10-Jun-14 5-Jul-14 7-Jul-14 083 Concrete Defects on Podium AECOM ATC 26-Aug-14 085 Core wall, Column and Slab edge not within tolerance AECOM ATC 26-Aug-14 087 Improper storage of GI Duct at P4 AECOM ATC 27-Aug-14 16-Sep-14 090 Core wall, Column and Slab edge not within tolerance AECOM ATC 26-Aug-14 096 DEWA and Shop Drawing AECOM ATC 14-Sep-14 099 FCU Storage on Site AECOM ATC 16-Sep-14 29-Sep-14 30-Sep-14 100 Concrete Defects on Level 30 AECOM ATC 17-Sep-14 101 Concrete Defects on level 31 AECOM ATC 23-Sep-14 102 FCU installed on site AECOM ATC 23-Sep-14 104 Application of waterproofing at level 8 not as per product recommendation AECOM ATC 28-Sep-14 O Title Engineer Issued To Date Issued Status File: Page 1 of 1 Printed On :- 12.10.2014 at 12:30
  • 243.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 19 Actions Log
  • 244.
    Project Issues /Actions Log as of 30 September 2014 Issue No. Date Identified Opened By Trans. No. Double Click DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Issue Description Owner Client Input? Original Due Date Revised / Closed Date Variance (Calendar Days) RAGC Recommended Solution(s) / Alternative(s) General Aspects G001 AECOM Updated Building Permit with the revised conditions (Related to DCD approval on level P5) RME Yes Closed Updated Building Permit with the revised conditions (Related to DCA NOC for building height) AECOM No Closed Updated Building Permit with the revised conditions (Related to Structural Steel Shop Drawing Approval) ATC/Notr No Low Item 3: Related to Structural Steel Shop Drawing Approval: Condition to be cleared prior to commencement of the related work above lev el 84. Updated Building Permit with the revised conditions (Related to Letter of appointment for Notre Dame Steel) ATC/Notr No Low Item 4: Related to Letter of appointment for Notre Dame Steel: it will be submitted when the shop drawings are ready. Condition to cleared prior to commencement of the related work. Updated Building Permit with the revised conditions (Related to External paving) ATC No Low Item 5: Related to External paving: to be approved prior to Building Completion Certificate application. Updated Building Permit with the revised conditions (Related to Thermal insulation approval from DM and ventilation for Chillers) AECOM/D M No Closed Updated Building Permit with the revised conditions (FIC final approval) AECOM/D M No Closed Nominations of PS items FENDI Flats N001 DAMAC Fit Out DAMAC 13.Nov.14 Med N002 DAMAC Light fittings DAMAC 22.Mär.15 Low N003 DAMAC Shower enclosures DAMAC 13.Nov.14 Med Ground Floor N004 DAMAC Fit-out for the main entrances of branded and non-branded DAMAC 07.Mai.15 Low N005 DAMAC FF & E DAMAC 07.Mai.15 Low N006 DAMAC Light fittings DAMAC Low P5 - Life Style N007 DAMAC P5 fit out DAMAC 29.Dez.14 Med N008 DAMAC P5 light fittings DAMAC Med N009 DAMAC FFE of lifestyle DAMAC 29.Dez.14 Med N010 DAMAC P5 Lockers DAMAC 30.Mär.15 Low N011 DAMAC P5 Jacuzzi & Steam Sauna DAMAC 12.Feb.15 Low N012 DAMAC P5 Acrylic panel enclosure for Jacuzzi DAMAC 30.Jul.15 Low N013 DAMAC Swimming pool package DAMAC 20.Aug.14 High N014 DAMAC Swimming Pool Furniture DAMAC Low General Façade lighting N015 DAMAC DAMAC 24.Feb.14 High N016 DAMAC Metal doors DAMAC 26.Aug.14 Closed Has been nominated on 26 Aug-14. N017 DAMAC Timber Doors DAMAC Closed There are no timber doors in the corridors. N018 DAMAC Internal/ external Signage DAMAC 20.Apr.15 Low Issues - Actions Log Page 1 of 3 Printed on: 13.10.2014 at 12:17
  • 245.
    Issue No. Date Identified Opened By Trans. No. Double Click Issue Description Owner Client Input? Original Due Date Revised / Closed Date Variance (Calendar Days) RAGC Recommended Solution(s) / Alternative(s) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Project Issues / Actions Log as of 30 September 2014 Structural Works S001 AECOM Zone B de-strutting sequencing and design (Variation to the scope). AECOM 15.Okt.14 High AECOM to propose the sequencing (Variation to the scope). S002 ATC Structural steel framing at P5 to 6 floor and mechanical floors not updated (reference FAC drawings). DAMAC Closed ALICO produced the design of secondary steel structure. S003 ALICO Slab edge clashes with the façade various upper levels 69,70 and 71. ALICO/ATC/ RME Med ATC/ALICO has to advice which cut out to follow @ level 69,70 and 71. S004 AECOM Leaks along diaphragm walls are causing delays to enabling works in raft, section B. AECOM/DA MAC High Allow IGS to contain the leaks. S005 AECOM Seepage through a hole in the diaphragm wall occurred in section DD. AECOM/DA MAC 15.Okt.14 High AECOM to submit proposal to have permanent solution to the diaphragm wall. S006 ATC Water proofing membrane for Landscaping area has to be changed AECOM/DA MAC Closed Material submitted by ATC and it is approved. Architectural Works A001 DAMAC Service access doors assessment. DAMAC High Supplier will submit the material submittal to DAMAC approval. A002 ATC Lift Lobby Marble to be finalized. AECOM/DA MAC Med ATC submitted prices and samples and AECOM/DAMAC to review and advice. A003 ATC Corridor tiles ATC Med Tiles ordered by ATC. Mock up to be done. A004 DAMAC (Skim coat + paint) vs. (plaster and paint) cost savings comparison was submitted by ATC. DAMAC Low DAMAC to decide. A005 DAMAC Paint: Select another supplier instead of ''Sherwin Williams'' AECOM/DA MAC Closed A006 ATC RFI 572 – Approved Kitchen Equipment’s Catalogue or Technical information and installation DAMAC Closed Catalogue was provided. ATC to follow the IFC drawings. A007 ATC RFI 656 – Bedroom Door – Marble Threshold Under the Door DAMAC Closed A008 AECOM Material Submittal 3445 - Glass for Balustrade and Glass Fin ATC Closed Sample is approved on 14-Septembe-14. A009 ATC The IFC for level 43 to 55 issued without doors and internal finishes schedules. RME Closed IFC submitted by RME. A010 AECOM Mock up for tiling works ATC High ATC to expedite the mock up to enable the work to progress in line with the programme of work. A011 AECOM Lack of progress in False Ceiling installation. ATC High ATC to expedite the work to progress in line with the programme of work. MEP and Specialists Works M001 AECOM Cooling Towers material submittal approval. DAMAC Closed Material submittal is approved on 6-Aug-14. M002 REMCO D14 and D29 VE items to be finalized commercially. D14:Chilled Water Pump D29: Corridor Pressurization ATC Closed M003 08.Jul.14 Phoenician Swimming pool plant design Phoenician Med Awaiting pool designer's full design package to be issued in order to allow DAMAC to proceed with the nomination. M004 Jobian Concept Water feature design (the scope of the services is within LON of the hard and soft landscape nomination however there is no design i.e. shape height etc..) RME Med DAMAC/Ramboll input is required. M005 REMCO Cost savings for PIR/ GI ducting ATC Closed M006 ATC Lack of ID-IFC drawings for GF,P5,69th and 70th floors withhold issuing the sanitary wares purchase order. DAMAC Med DAMAC input is required to issue ID package with Toilet accessories details and then DAMAC has to issue the nomination for sanitary ware in these floors. M007 ATC There are missing electrical points in floors 43rd and above RME Closed M008 AECOM AECOM advised that level P5 ( F.F. / F.A.) has been submitted to DCD however Ramboll Arch drawing should be updated in line with DM requirements. RME Low Ramboll to update the architectural drawings for level P5. Issues - Actions Log Page 2 of 3 Printed on: 13.10.2014 at 12:17
  • 246.
    Issue No. Date Identified Opened By Trans. No. Double Click Issue Description Owner Client Input? Original Due Date Revised / Closed Date Variance (Calendar Days) RAGC Recommended Solution(s) / Alternative(s) DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Project Issues / Actions Log as of 30 September 2014 M009 AECOM DEWA submittal pending renewal NOC for power allocation. AECOM/DA MAC High AECOM/DAMAC are following up with Emmar for the NOC letter addressed to DEWA. M010 AECOM Balcony rain water risers coordination with the façade. DAMAC Low Proposal was submitted to DAMAC. M011 AECOM RCP plans / MEP Services in Non False Ceiling Area at Living / Dining & Bedrooms (L 6 - L38). RME Closed M012 AECOM MEP discrepancies in the typical floors (Level 43-84). RME Closed M013 AECOM Discrepancies in Lift machine rooms at Level 63-68 . RME Closed M014 AECOM Missing Electrical points (Level 43 and above). RME Closed M015 AECOM Electrical Load Schedule. RME Closed M016 ATC Re-nomination of sanitary wares to be done by DAMAC. DAMAC Med DAMAC to re-nominate the package. M017 AECOM LPO for Bus Bars and LV Panels. REMCO High REMCO has to Release the LPO for Bus Bars and LV Panels Façade Works F001 ALICO Composite panel mock up approval pending. DAMAC Closed Color is selected by DAMAC. F002 DAMAC Stone Cladding/ composite cladding. ATC Low DAMAC advised that the decision is to proceed with stone cladding. Sample sent to ATC. F003 ATC Openings in level 86 have to be given for BMU operation. ALICO Med ALICO to provide opening provisions in coordinations with BMU requirments. F004 ATC Areas that arent accessable for glass replacement at SE and NW elevations. ATC Med ATC to coordinate with ALICO and Danway to propose a solution. F005 AECOM Production and shop drawings for secondary steel structure. ATC High ATC to submit the shop drawings for approval in order to proceed with releasing the purchase order. This Week's totals Total 11 High 64 15 Med 15 Low 23 Closed Issues - Actions Log Page 3 of 3 Printed on: 13.10.2014 at 12:17
  • 247.
    QATAR ACCOUNT MANAGEMENT PROGRAM Damac Heights Appendix 20 AECOM’s Organization Chart
  • 248.
    AECOM Organization Chart DAMAC Gulf Properties L.L.C DAMAC Heights at Dubai Marina Electromechanical Architectural Structural Electromechanical Architectural Structural Project Director Peer Review Team Fuad Hasan (Abu Dhabi) Resident Engineer Radhi Mohamed Document Controller Abdul Latheef Sr. Electrical Engineer Planning Manager Project Secretary Abdulla Muhyideen Sr. Architect Sr. Structural Engineer Sr. HSE Officer MEP Manager / Mechanical Ahmed Raouf Hasan Abuhaiba Stakeholder Manager Legend Management Staff Supervision Staff Helath and Safety Project Control Documents Control Documents Control Helath and Safety Project Control Mateen Khawajah Sameh Kandil Ayman Haddad Reuben Samaniego Mohammad Faisi Mechanical Inspector Percival Vicente Architectural Inspector Electrical Inspector Shibu Mathew Sanat Rane Architectural Inspector TBA Structural Inspector Roberto Magtira Structural Inspector Frederick Abellar
  • 249.
    Prepared by AECOMMiddle East Limited PO Box 51028, Dubai United Arab Emirates www.aecom.com © AECOM 2014 This document is the property of AECOM and DAMAC.
