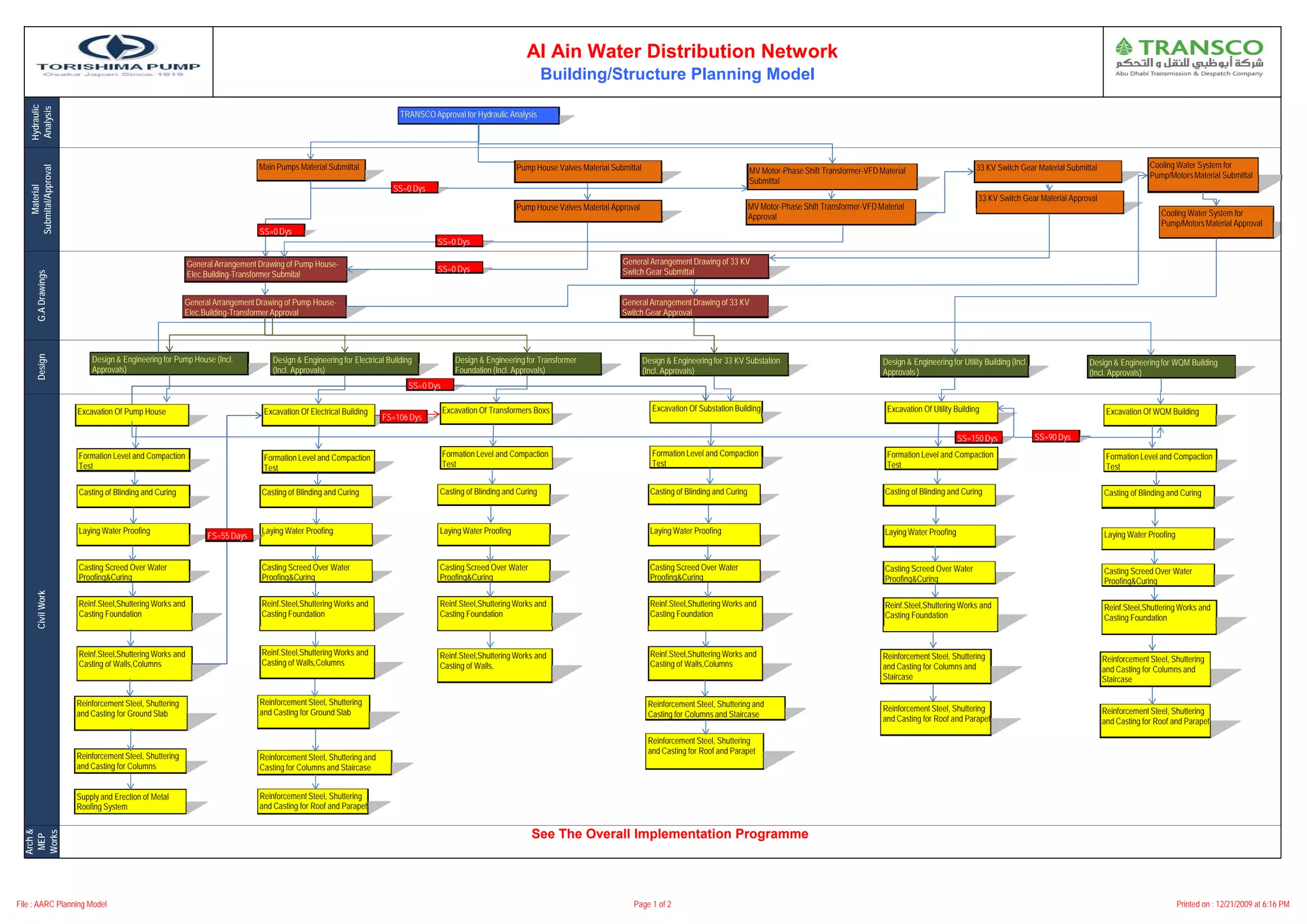

The document outlines the planning and approval process for a water distribution network project. It lists the various materials, designs, engineering drawings and approvals required. It then lays out the civil works and construction activities needed to build pump houses, electrical buildings, surge vessels, pipelines and other infrastructure. These include tasks like excavation, foundation work, structural elements, mechanical, electrical and plumbing installations. The program shows the sequence and durations for each stage from initial submissions and approvals through to completion of construction.
