Monitoring and Evaluation
       System for CAADP
        Implementation
                             Babatunde Omilola
Coordinator, Regional Strategic Analysis and Knowledge Support System (ReSAKSS)
                                      IFPRI

           CAADP Monitoring and Evaluation Framework Validation Workshop
                     Indaba Hotel, Johannesburg, South Africa
                                  March 1-3, 2010

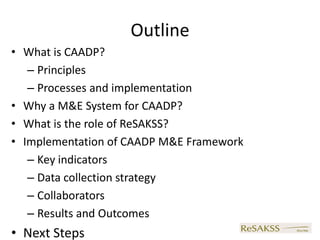

Outline
• What is CAADP?
   – Principles
   – Processes and implementation
• Why a M&E System for CAADP?
• What is the role of ReSAKSS?

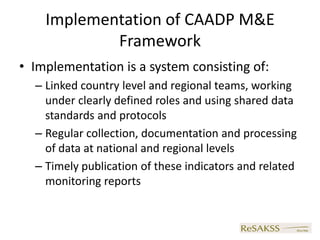

• Implementation of CAADP M&E Framework
   – Key indicators
   – Data collection strategy
   – Collaborators
   – Results and Outcomes
• Next Steps

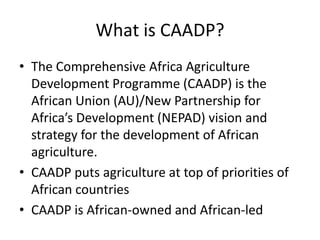

What is CAADP?
• The Comprehensive Africa Agriculture
  Development Programme (CAADP) is the
  African Union (AU)/New Partnership for
  Africa’s Development (NEPAD) vision and
  strategy for the development of African
  agriculture.
• CAADP puts agriculture at top of priorities of
  African countries
• CAADP is African-owned and African-led

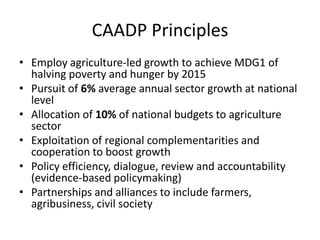

CAADP Principles
• Employ agriculture-led growth to achieve MDG1 of
  halving poverty and hunger by 2015
• Pursuit of 6% average annual sector growth at national
  level
• Allocation of 10% of national budgets to agriculture
  sector
• Exploitation of regional complementarities and
  cooperation to boost growth
• Policy efficiency, dialogue, review and accountability
  (evidence-based policymaking)
• Partnerships and alliances to include farmers,
  agribusiness, civil society
CAADP Process
• The principles are achieved through:
    – the strategic functions of CAADP,
    – the guidance and involvement of the Regional Economic Communities
      (RECs), and
    – the national roundtable process
• These activities surround four key pillars, led by Africa-based technical
  institutions:
    – Pillar 1: extending the area under sustainable land management
      (University of Zambia)
    – Pillar 2: Improving rural infrastructure and trade-related capacities for
      market access (Conference of Ministers of Agriculture of West and Central
      Africa (CMA/AOC))
    – Pillar 3: Increasing food supply and reducing hunger (University of
      KwaZulu-Natal)
    – Pillar 4: Agricultural research, technology dissemination and adoption
      (Forum for Agricultural Research in Africa (FARA))

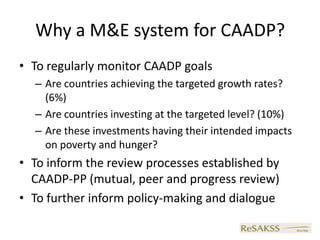

Why a M&E system for CAADP?
• To regularly monitor CAADP goals
  – Are countries achieving the targeted growth rates?
    (6%)
  – Are countries investing at the targeted level? (10%)
  – Are these investments having their intended impacts
    on poverty and hunger?
• To inform the review processes established by
  CAADP-PP (mutual, peer and progress review)
• To further inform policy-making and dialogue

Idea behind M&E framework
                  Greater/better distributed
                   poverty reduction & food and nutrition                      t   a   r
                             security outcomes                                 r   n   e
Other factors
                                                                               a   a   p
                     Accelerated agricultural growth &                         c   l   o
                          Greater market access                                k   y   r
Other factors                                                                  i   s   t
                          More enabling policies &                             n   i   i
                     Greater/more efficient allocation of                      g   s   n
                          agricultural investments                                     g
Other factors                                                         More effective
                                  National level
                                        1
                                                                       Processes
                                     8
                                   Roundtable
                                            2 P4
                                             P3

                 Regional level
                                   7    P2
                                                           Africa-wide level
  Global level                         P1              3

                 Early actions
                                   6                           Declarations
  Commitments                           5
                                                   4

                                                                  Decisions

Page 7

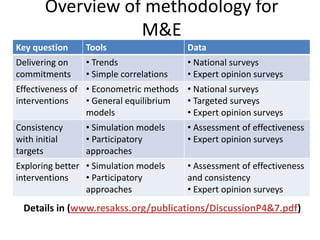

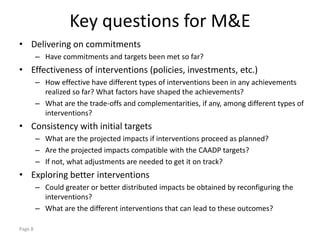

Key questions for M&E
• Delivering on commitments
         – Have commitments and targets been met so far?
• Effectiveness of interventions (policies, investments, etc.)
         – How effective have different types of interventions been in any achievements
           realized so far? What factors have shaped the achievements?
         – What are the trade-offs and complementarities, if any, among different types of
           interventions?

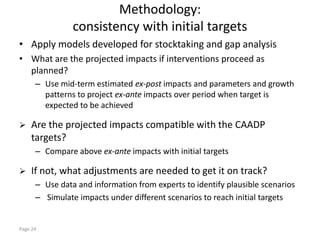

• Consistency with initial targets
         – What are the projected impacts if interventions proceed as planned?
         – Are the projected impacts compatible with the CAADP targets?
         – If not, what adjustments are needed to get it on track?
• Exploring better interventions
         – Could greater or better distributed impacts be obtained by reconfiguring the
           interventions?
         – What are the different interventions that can lead to these outcomes?

Page 8

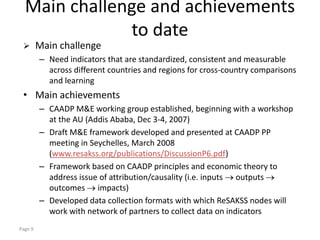

Main challenge and achievements
              to date
        Main challenge
         – Need indicators that are standardized, consistent and measurable
           across different countries and regions for cross-country comparisons
           and learning
 • Main achievements
         – CAADP M&E working group established, beginning with a workshop
           at the AU (Addis Ababa, Dec 3-4, 2007)
         – Draft M&E framework developed and presented at CAADP PP
           meeting in Seychelles, March 2008
           (www.resakss.org/publications/DiscussionP6.pdf)
         – Framework based on CAADP principles and economic theory to
           address issue of attribution/causality (i.e. inputs outputs
           outcomes impacts)
         – Developed data collection formats with which ReSAKSS nodes will
           work with network of partners to collect data on indicators

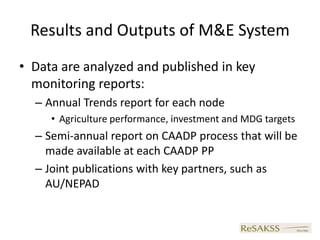

Page 9

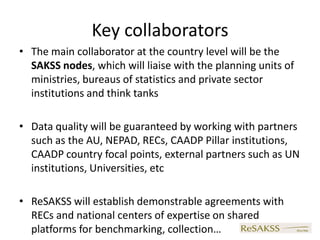

ReSAKSS Role in CAADP M&E
• M&E of agricultural development initiatives in Africa is key
  element of ReSAKSS strategic analysis

• CAADP M&E Technical Working Group met in 2008 and
  designed M&E Framework for CAADP
   – See ReSAKSS Working Paper No. 6

• ReSAKSS has now outlined a plan for implementing this
  framework

• As mandated by 5th CAADP-PP in Abuja, the CAADP M&E
  framework will be validated in collaboration with
  AU/NEPAD and other stakeholders in South Africa between
  March 1 and 3, 2010

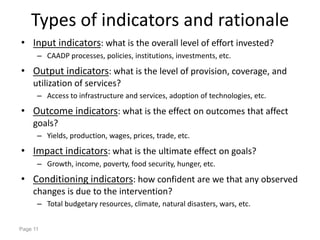

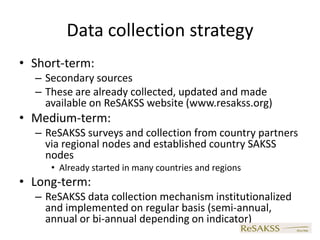

Types of indicators and rationale
• Input indicators: what is the overall level of effort invested?
      – CAADP processes, policies, institutions, investments, etc.

• Output indicators: what is the level of provision, coverage, and
     utilization of services?
      – Access to infrastructure and services, adoption of technologies, etc.

• Outcome indicators: what is the effect on outcomes that affect
     goals?
      – Yields, production, wages, prices, trade, etc.

• Impact indicators: what is the ultimate effect on goals?
      – Growth, income, poverty, food security, hunger, etc.

• Conditioning indicators: how confident are we that any observed
     changes is due to the intervention?
      – Total budgetary resources, climate, natural disasters, wars, etc.

Page 11
Input indicators:
                    CAADP roundtable processIndicators:
                            Program       Key
                   Program
                implementation      scaling up and                  Credible and relevant
                   and M&E             out, etc.
                                                                     evidence used in design
                                                                     of investment program
                            National Focal
                            Point appointed                         Inclusive participation
                                                 CAADP               of stakeholders in
                                Pillar 4         process
                              Research &        launched             program design
                              Technology
Roundtable                 Pillar 3
                                                                    Investment program
conference               Food security                               aligned with CAADP
  held &                                           Steering &
                          Pillar 2
                                                    Technical
                                                                     principles and targets
 compact              Markets & trade
  signed
                       Pillar 1
                                                  Committees        Investment program
                                                   appointed
                    Land & water                                     technically reviewed
                    management
        National
        compact                                                     Mechanisms in place
                                         Cabinet memo
      developed &
                       Stock taking       discussed &
                                                                     for implementation and
       discussed
                     and gap analysis      approved                  M&E of the program
                        completed

                                                           Page 12
Input indicators:
            enabling conditions (other processes, policies, institutions)
                                                                          Key Indicators:
                         National Policy                               • Policies for private
     Gov’t              Processes/Events                  Donors         sector development
                        CAADP, SWAP, MTEF,                              (property rights, access to
                        Exp Reviews, Donor                              credit, contract enforcement,
    Private                harmonization,                               licensing, competition, …)
                                                          Others
    Sector               Elections, Law, etc.                          • Policies on equity
                                                                        (access of poor and vulnerable
                                                                        groups to resources, markets,
                                                                        food, and nutrition)
 Regional Level        Africa-wide level            Global level
                                                                       • Governance (political
 Actors    Process      Actors     Process        Actors                stability, accountability,
                                                            Process
                                                                        government effectiveness,
RECs, Reg Summit,       AU, Int’l Assembly       G-8, G-20, Conventi    regulatory quality, rule of law,
Orgs., etc. Reviews,   Orgs., etc. , Summit,     WTO, etc. ons, etc.    control of corruption)
              etc.                   etc.
                                                                       • Harmonized policies and
                                                                         strategies
                                                                       • Commitments met

                                                Page 13

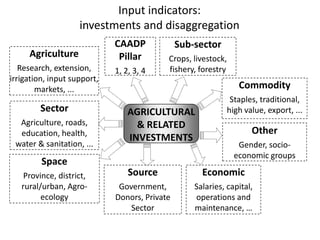

Input indicators:
                    investments and disaggregation
                             CAADP             Sub-sector
     Agriculture              Pillar       Crops, livestock,
   Research, extension,      1, 2, 3, 4    fishery, forestry
irrigation, input support,
        markets, ...                                            Commodity
                                                              Staples, traditional,
        Sector                   AGRICULTURAL                high value, export, ...
  Agriculture, roads,              & RELATED
  education, health,                                                Other
                                 INVESTMENTS
 water & sanitation, ...                                        Gender, socio-
                                                               economic groups
         Space
    Province, district,          Source              Economic
   rural/urban, Agro-         Government,          Salaries, capital,
         ecology             Donors, Private       operations and
                                 Sector            maintenance, …

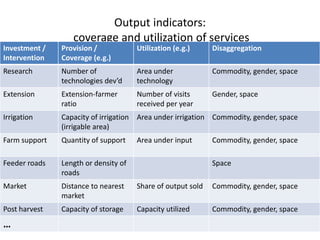

Output indicators:
                  coverage and utilization of services
Investment /   Provision /            Utilization (e.g.)     Disaggregation
Intervention   Coverage (e.g.)
Research       Number of              Area under             Commodity, gender, space
               technologies dev’d     technology
Extension      Extension-farmer       Number of visits       Gender, space
               ratio                  received per year
Irrigation     Capacity of irrigation Area under irrigation Commodity, gender, space
               (irrigable area)
Farm support   Quantity of support    Area under input       Commodity, gender, space

Feeder roads   Length or density of                          Space
               roads
Market         Distance to nearest    Share of output sold   Commodity, gender, space
               market
Post harvest   Capacity of storage    Capacity utilized      Commodity, gender, space
…
Outcome indicators:
                   agricultural sector performance
                         Production, trade and prices    Sector growth and
                                       by:                contribution to
  Growth returns to                                       overall GDP by:
                         sub-sector, commodity, space
  different types of
   investments by:                                             Space
sub-sector, commodity,                                     Sub-sector growth
        space                  AGRICULTURAL                and contribution to
                                  SECTOR                       AgGDP by:
Productivity of factors        PERFORMANCE                       Space
 (land, labor, capital)
    and inputs by:
                                                         Commodity growth,
sub-sector, commodity,    Use of factors (land, labor,
                                                           contribution to
gender, socio-economic      capital) and inputs by:
                                                             AgGDP by:
     group, space       sub-sector, commodity, gender,
                                                               Space
                         socio-economic group, Space

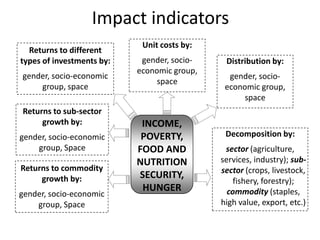

Impact indicators
                            Unit costs by:
  Returns to different
types of investments by:    gender, socio-    Distribution by:
                           economic group,
gender, socio-economic                         gender, socio-
                                space
    group, space                              economic group,
                                                   space
Returns to sub-sector
     growth by:             INCOME,
gender, socio-economic      POVERTY,          Decomposition by:
    group, Space           FOOD AND           sector (agriculture,
                           NUTRITION         services, industry); sub-
Returns to commodity                         sector (crops, livestock,
     growth by:            SECURITY,
                                                 fishery, forestry);
                            HUNGER             commodity (staples,
gender, socio-economic
    group, Space                             high value, export, etc.)
Implementation of CAADP M&E
            Framework
• Implementation is a system consisting of:
  – Linked country level and regional teams, working
    under clearly defined roles and using shared data
    standards and protocols
  – Regular collection, documentation and processing
    of data at national and regional levels
  – Timely publication of these indicators and related
    monitoring reports
Key indicators
              • Formal communications, declarations
              • Compact signings (country and regional)
              • Review and dialogue
 Processes    • Mutual accountability framework

             • Levels and Shares
             • Sub-sector
Agricultural • Spatial
Investments

                                                            Other factors:
             • Levels and growth rates
                                                            trade, hunger,
Agricultural • Production and Productivity                inputs, prices, etc.
  Growth

              • Headcount index
              • Absolute numbers
 Poverty      • MDG projections
Reduction
Overview of methodology for
                  M&E
Key question    Tools                   Data
Delivering on   • Trends                • National surveys
commitments     • Simple correlations   • Expert opinion surveys
Effectiveness of • Econometric methods • National surveys
interventions    • General equilibrium • Targeted surveys
                 models                • Expert opinion surveys
Consistency     • Simulation models     • Assessment of effectiveness
with initial    • Participatory         • Expert opinion surveys
targets         approaches
Exploring better • Simulation models    • Assessment of effectiveness
interventions    • Participatory        and consistency
                 approaches             • Expert opinion surveys
 Details in (www.resakss.org/publications/DiscussionP4&7.pdf)

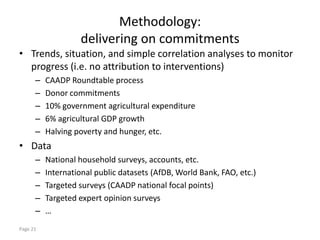

Methodology:
                   delivering on commitments
• Trends, situation, and simple correlation analyses to monitor
  progress (i.e. no attribution to interventions)
      –   CAADP Roundtable process
      –   Donor commitments
      –   10% government agricultural expenditure
      –   6% agricultural GDP growth
      –   Halving poverty and hunger, etc.
• Data
      –   National household surveys, accounts, etc.
      –   International public datasets (AfDB, World Bank, FAO, etc.)
      –   Targeted surveys (CAADP national focal points)
      –   Targeted expert opinion surveys
      –   …
Page 21

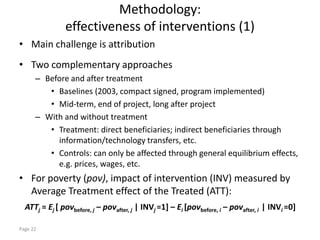

Methodology:
               effectiveness of interventions (1)
• Main challenge is attribution
• Two complementary approaches
      – Before and after treatment
         • Baselines (2003, compact signed, program implemented)
         • Mid-term, end of project, long after project
      – With and without treatment
         • Treatment: direct beneficiaries; indirect beneficiaries through
           information/technology transfers, etc.
         • Controls: can only be affected through general equilibrium effects,
           e.g. prices, wages, etc.
• For poverty (pov), impact of intervention (INV) measured by
  Average Treatment effect of the Treated (ATT):
  ATTj = Ej [ povbefore, j – povafter, j | INVj =1] – Ei [povbefore, i – povafter, i | INVi =0]

Page 22

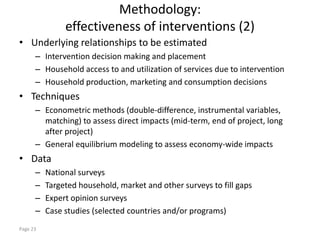

Methodology:
               effectiveness of interventions (2)
• Underlying relationships to be estimated
      – Intervention decision making and placement
      – Household access to and utilization of services due to intervention
      – Household production, marketing and consumption decisions
• Techniques
      – Econometric methods (double-difference, instrumental variables,
        matching) to assess direct impacts (mid-term, end of project, long
        after project)
      – General equilibrium modeling to assess economy-wide impacts
• Data
      –   National surveys
      –   Targeted household, market and other surveys to fill gaps
      –   Expert opinion surveys
      –   Case studies (selected countries and/or programs)
Page 23
Methodology:
                consistency with initial targets
• Apply models developed for stocktaking and gap analysis
• What are the projected impacts if interventions proceed as
  planned?
      – Use mid-term estimated ex-post impacts and parameters and growth
        patterns to project ex-ante impacts over period when target is
        expected to be achieved

   Are the projected impacts compatible with the CAADP
    targets?
      – Compare above ex-ante impacts with initial targets

   If not, what adjustments are needed to get it on track?
      – Use data and information from experts to identify plausible scenarios
      – Simulate impacts under different scenarios to reach initial targets

Page 24
Methodology:
                exploring better interventions
• Could greater or better distributed impacts be obtained by
  reconfiguring the interventions?
      – Even if interventions are consistent with the initial targets, can
        simulate impacts under different composition of investments to
        identify (in)efficiencies in implementation
      – Use estimated ex-post impacts and parameters from cross-country
        reviews and information from experts to identify plausible scenarios
      – Value of indicators associated with simulated impacts of the desirable
        scenarios can be used as guidelines to set new targets
   What are the different interventions that can lead to these
    outcomes?
      – Composition of investments associated with desirable scenarios from
        preceding analysis

Page 25
Data collection strategy
• Short-term:
  – Secondary sources
  – These are already collected, updated and made
    available on ReSAKSS website (www.resakss.org)
• Medium-term:
  – ReSAKSS surveys and collection from country partners
    via regional nodes and established country SAKSS
    nodes
     • Already started in many countries and regions
• Long-term:
  – ReSAKSS data collection mechanism institutionalized
    and implemented on regular basis (semi-annual,
    annual or bi-annual depending on indicator)
Reporting and dissemination of M&E results
• ReSAKSS Annual Trends Report and briefs to be completed by
  end of September of each year―timely for CAADP PP meeting

• ReSAKSS website (www.resakss.org) to view and download
  trends, data, charts, supporting research publications, etc.

• Various other media and presentations to review M&E
  information and results of analyses:
      –   CAADP PP (Africa wide)
      –   CAADP advisory councils (REC level)
      –   ReSAKSS steering committee meetings (REC level)
      –   Other regional- and country-level policy dialogues

Page 27
Tracking Progress of CAADP: ReSAKSS Website
              www.resakss.org
Users can customize
                                    the map and charts
 The ReSAKSS website allows
                                   based on the specific
 users to easily track progress
                                   information they are
            against
                                    looking for, whether
 the CAADP and MDG targets
                                      that be regional
while also accessing a wealth of
                                       information or
    knowledge and data on
                                      country-specific
  agricultural development in
                                         information
             Africa
Key collaborators
• The main collaborator at the country level will be the
  SAKSS nodes, which will liaise with the planning units of
  ministries, bureaus of statistics and private sector
  institutions and think tanks

• Data quality will be guaranteed by working with partners
  such as the AU, NEPAD, RECs, CAADP Pillar institutions,
  CAADP country focal points, external partners such as UN
  institutions, Universities, etc

• ReSAKSS will establish demonstrable agreements with
  RECs and national centers of expertise on shared
  platforms for benchmarking, collection…
Roles and Responsibilities in Implementation of
              CAADP M&E Framework
• Need for serious efforts by the RECs and their member
  countries to internalize the collection and provision of the
  data within their own M&E systems
• This should be tied with serious efforts to meet
  International standards in reporting
• Ultimately, the responsibility of collecting and analyzing the
  data and reporting the results must be with the country
  itself
• ReSAKSS and network of partners can facilitate this
   – Consulting with the RECS and CAADP country focal points
   – Strengthening capacity of national statistical bureaus
   – …
Results and Outputs of M&E System
• Data collected are openly available for review,
  analysis and download on ReSAKSS website
  – 28 indicators already tracked and analyzed on
    website
Results and Outputs of M&E System
• Data are analyzed and published in key
  monitoring reports:
  – Annual Trends report for each node
     • Agriculture performance, investment and MDG targets
  – Semi-annual report on CAADP process that will be
    made available at each CAADP PP
  – Joint publications with key partners, such as
    AU/NEPAD
Where are we now?
• Almost 7 years after CAADP, has there been any
  progress toward the goals?
• The Process:
   – 13 countries and 1 region have signed CAADP compacts
• Agricultural Spending/Investment:
   – The number of countries spending at least 10% of budgets
     on agriculture has increased since 2002

• Agricultural Growth:
   – At the continent level agricultural growth has increased
     since 2002
   – The number of countries with annual agricultural growth
     rates of 6% or more has increased since 2002

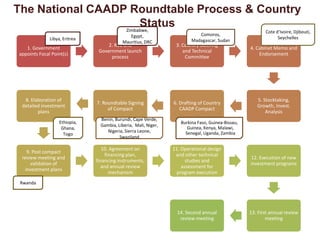

The National CAADP Roundtable Process & Country
                       Status
                  Zimbabwe,                                                                               Cote d’Ivoire, Djibouti,
                                               Egypt,                       Comoros,
              Libya, Eritrea                                                                                    Seychelles
                                            Mauritius, DRC               Madagascar, Sudan
                                    2. REC and                    3. Country Steering
   1. Government                                                                                   4. Cabinet Memo and
                                Government launch                    and Technical
appoints Focal Point(s)                                                                                Endorsement
                                     process                          Committee

  8. Elaboration of                                                                                   5. Stocktaking,
                               7. Roundtable Signing             6. Drafting of Country
 detailed investment                                                                                  Growth, Invest.
                                    of Compact                      CAADP Compact
        plans                                                                                             Analysis
                                 Benin, Burundi, Cape Verde,
                   Ethiopia,                                        Burkina Faso, Guinea-Bissau,
                                 Gambia, Liberia, Mali, Niger,
                    Ghana,                                             Guinea, Kenya, Malawi,
                                    Nigeria, Sierra Leone,            Senegal, Uganda, Zambia
                     Togo
                                          Swaziland

                                  10. Agreement on               11. Operational design
   9. Post compact
                                    financing plan,               and other technical
 review meeting and                                                                                12. Execution of new
                               financing instruments,                  studies and
     validation of                                                                                 investment programs
                                  and annual review                  assessment for
  investment plans
                                      mechanism                   program execution
 Rwanda

                                                                   14. Second annual               13. First annual review
                                                                    review meeting                         meeting

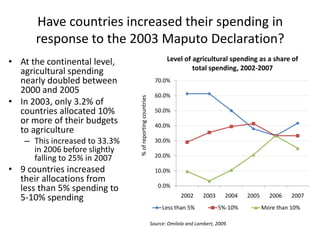

Government spending on agriculture: Progress
        towards the Maputo Declaration target
    • The African continent as a whole has not met the
      10% target (current spending at 6-8 percent)
    • But, this varies by country                 Only 8
                                                                                          countries have
                           Agricultural Expenditures as a share of total (%), 2007         met the 10%
    25                                                                                        target
    20
                          CURRENT, 2007 (Unless otherwise noted)
    15
%

    10
    5
    0
           Central African…

           Madagascar**

               Ghana****
         Guinea Bissau***

               Morocco**
                Gabon***

                      Mali
                    Nigeria
                    DRC**

                   Egypt**

             Swaziland**

                Benin****
              Burundi***

                 Tunisia**

                  Chad***
               Kenya****

             Uganda****

               Tanzania**

                    Malawi
                 Sudan***

                  Zambia*

               Gambia***

                   Senegal

                    Niger*
             Cote d'Ivoire

                Lesotho**

                      Togo
              Mauritius**

               Namibia**

               Ethiopia**
                   Rwanda

                 Botswana

           Mauritania***

          Mozambique**

               Guinea***
             Cameroon**

             Zimbabwe**

            Burkina Faso*
                                         *=2006; **=2005; ***=2004; ****=2008 estimates
    Source: Omilola and Lambert, 2009.
Have countries increased their spending in
      response to the 2003 Maputo Declaration?
• At the continental level,                                      Level of agricultural spending as a share of
                                                                          total spending, 2002-2007
  agricultural spending
  nearly doubled between                                    70.0%
  2000 and 2005                                             60.0%

                               % of reporting countries
• In 2003, only 3.2% of
  countries allocated 10%                                   50.0%
  or more of their budgets                                  40.0%
  to agriculture
   – This increased to 33.3%                                30.0%
     in 2006 before slightly
     falling to 25% in 2007                                 20.0%

• 9 countries increased                                     10.0%
  their allocations from
                                                             0.0%
  less than 5% spending to
  5-10% spending                                                       2002      2003      2004   2005     2006    2007
                                                               Less than 5%             5%-10%           More than 10%

                                                          Source: Omilola and Lambert, 2009.
Agricultural expenditure as a share of
                    agricultural GDP
    • Measures government spending on agriculture relative to the size of that
      country's agriculture sector
    • Under this measure, more countries fall into the category of low budget
      support to agriculture
                   Agricultural expenditures as a share of agricultural GDP, 2007
    80

    60     The range is
                                                    CURRENT, 2007 (Unless otherwise noted)
           considerable
%

    40
            (1 to 60%)
    20

    0

                                                        *=2006; **=2005; ***=2008 estimates
On aggregate , Africa spends between 5-7%
                                                      Source: Omilola and Lambert, 2009.
    of agricultural GDP on agriculture,
 compared to 15% in Asia during its Green
                Revolution
-36
                                                                                                    -30
                                                                                                          -24
                                                                                                                -18
                                                                                                                      -12
                                                                                                                            -6
                                                                                                                                             12
                                                                                                                                                       18
                                                                                                                                                                                           24

                                                                                                                                 0
                                                                                                                                     6
                                                                                                           Eritrea
                                                                                                   Gambia, The
                                                                                                      Zimbabwe
                                                                                                         Senegal

Source: WDI
                                                                                                          Tunisia
                                                                                                     Mauritania

                                    2008:
                                                                                                          Malawi
                                                                                                         Lesotho
                                                                                                                                                       2002:
                                                                                                     Cape Verde                      6% CAADP target

                  6% CAADP target
                                                                                                           Gabon
                                                                                                             Mali
                                                                                                           Kenya
                                                                                                   Cote d'Ivoire
                                                                                                         Ethiopia
                                                                                                          Zambia
                                                                                                    Madagascar
                                                                                                          Algeria
                                                                                                              CAR
                                                                                                             Chad
                                                                                                  Guinea-Bissau
                                                                                                       Botswana
                                                                                                              DRC
                                                                                                      Seychelles
                                                                                                      Swaziland
                                                                                                            Niger
                                                                                                   Burkina Faso
                                                                                                         Djibouti
                                                                                                           Sudan
                                                                                                            Egypt
                                                                                                      Cameroon

        Page 39
                                                                                                          Uganda
                                                                                                           Ghana
                                                                                                         Burundi
                                                                                                          Nigeria
                                                                                                        Comoros
                                                                                                       Mauritius
                                                                                                        Morocco
                                                                                                        Tanzania
                                                                                                                                                                                                            Agricultural GDP growth

                                                                                                          Guinea
                                                                                                    South Africa
                                                                                                             Togo
                                                                                                            Benin
                                                                                                        Namibia
                                                                                                                                                       Only 9 countries achieved 6% or more annual growth

                                    At least 20 countries achieved 6% or more annual growth

                                                                                                   Mozambique
                                                                                                    Sao Tome &…
                                                                                                          Angola
                                                                                                         Rwanda
                                                                                               Equatorial Guinea

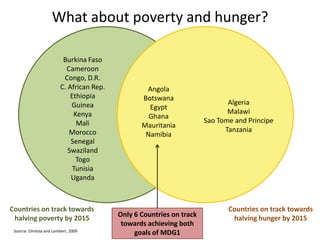

What about poverty and hunger?

                          Burkina Faso
                           Cameroon
                          Congo, D.R.
                         C. African Rep.           Angola
                             Ethiopia             Botswana
                             Guinea                                           Algeria
                                                    Egypt
                              Kenya                                           Malawi
                                                    Ghana
                               Mali                                    Sao Tome and Principe
                                                  Mauritania
                            Morocco                                          Tanzania
                                                   Namibia
                             Senegal
                            Swaziland
                               Togo
                              Tunisia
                             Uganda

Countries on track towards                                                    Countries on track towards
 halving poverty by 2015                   Only 6 Countries on track           halving hunger by 2015
                                            towards achieving both
 Source: Omilola and Lambert, 2009
                                                goals of MDG1
•

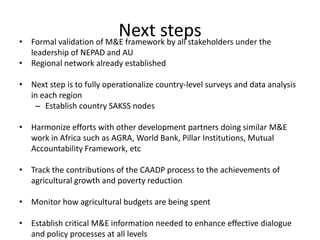

                           Next steps
    Formal validation of M&E framework by all stakeholders under the
  leadership of NEPAD and AU
• Regional network already established

• Next step is to fully operationalize country-level surveys and data analysis
  in each region
   – Establish country SAKSS nodes

• Harmonize efforts with other development partners doing similar M&E
  work in Africa such as AGRA, World Bank, Pillar Institutions, Mutual
  Accountability Framework, etc

• Track the contributions of the CAADP process to the achievements of
  agricultural growth and poverty reduction

• Monitor how agricultural budgets are being spent

• Establish critical M&E information needed to enhance effective dialogue
  and policy processes at all levels
Thank you.

Monitoring and Evaluation System for CAADP Implementation_2010

  • 1.
    Monitoring and Evaluation System for CAADP Implementation Babatunde Omilola Coordinator, Regional Strategic Analysis and Knowledge Support System (ReSAKSS) IFPRI CAADP Monitoring and Evaluation Framework Validation Workshop Indaba Hotel, Johannesburg, South Africa March 1-3, 2010
  • 2.
    Outline • What isCAADP? – Principles – Processes and implementation • Why a M&E System for CAADP? • What is the role of ReSAKSS? • Implementation of CAADP M&E Framework – Key indicators – Data collection strategy – Collaborators – Results and Outcomes • Next Steps
  • 3.
    What is CAADP? •The Comprehensive Africa Agriculture Development Programme (CAADP) is the African Union (AU)/New Partnership for Africa’s Development (NEPAD) vision and strategy for the development of African agriculture. • CAADP puts agriculture at top of priorities of African countries • CAADP is African-owned and African-led
  • 4.
    CAADP Principles • Employagriculture-led growth to achieve MDG1 of halving poverty and hunger by 2015 • Pursuit of 6% average annual sector growth at national level • Allocation of 10% of national budgets to agriculture sector • Exploitation of regional complementarities and cooperation to boost growth • Policy efficiency, dialogue, review and accountability (evidence-based policymaking) • Partnerships and alliances to include farmers, agribusiness, civil society
  • 5.
    CAADP Process • Theprinciples are achieved through: – the strategic functions of CAADP, – the guidance and involvement of the Regional Economic Communities (RECs), and – the national roundtable process • These activities surround four key pillars, led by Africa-based technical institutions: – Pillar 1: extending the area under sustainable land management (University of Zambia) – Pillar 2: Improving rural infrastructure and trade-related capacities for market access (Conference of Ministers of Agriculture of West and Central Africa (CMA/AOC)) – Pillar 3: Increasing food supply and reducing hunger (University of KwaZulu-Natal) – Pillar 4: Agricultural research, technology dissemination and adoption (Forum for Agricultural Research in Africa (FARA))
  • 6.
    Why a M&Esystem for CAADP? • To regularly monitor CAADP goals – Are countries achieving the targeted growth rates? (6%) – Are countries investing at the targeted level? (10%) – Are these investments having their intended impacts on poverty and hunger? • To inform the review processes established by CAADP-PP (mutual, peer and progress review) • To further inform policy-making and dialogue
  • 7.
    Idea behind M&Eframework Greater/better distributed poverty reduction & food and nutrition t a r security outcomes r n e Other factors a a p Accelerated agricultural growth & c l o Greater market access k y r Other factors i s t More enabling policies & n i i Greater/more efficient allocation of g s n agricultural investments g Other factors More effective National level 1 Processes 8 Roundtable 2 P4 P3 Regional level 7 P2 Africa-wide level Global level P1 3 Early actions 6 Declarations Commitments 5 4 Decisions Page 7
  • 8.
    Key questions forM&E • Delivering on commitments – Have commitments and targets been met so far? • Effectiveness of interventions (policies, investments, etc.) – How effective have different types of interventions been in any achievements realized so far? What factors have shaped the achievements? – What are the trade-offs and complementarities, if any, among different types of interventions? • Consistency with initial targets – What are the projected impacts if interventions proceed as planned? – Are the projected impacts compatible with the CAADP targets? – If not, what adjustments are needed to get it on track? • Exploring better interventions – Could greater or better distributed impacts be obtained by reconfiguring the interventions? – What are the different interventions that can lead to these outcomes? Page 8
  • 9.
    Main challenge andachievements to date  Main challenge – Need indicators that are standardized, consistent and measurable across different countries and regions for cross-country comparisons and learning • Main achievements – CAADP M&E working group established, beginning with a workshop at the AU (Addis Ababa, Dec 3-4, 2007) – Draft M&E framework developed and presented at CAADP PP meeting in Seychelles, March 2008 (www.resakss.org/publications/DiscussionP6.pdf) – Framework based on CAADP principles and economic theory to address issue of attribution/causality (i.e. inputs outputs outcomes impacts) – Developed data collection formats with which ReSAKSS nodes will work with network of partners to collect data on indicators Page 9
  • 10.
    ReSAKSS Role inCAADP M&E • M&E of agricultural development initiatives in Africa is key element of ReSAKSS strategic analysis • CAADP M&E Technical Working Group met in 2008 and designed M&E Framework for CAADP – See ReSAKSS Working Paper No. 6 • ReSAKSS has now outlined a plan for implementing this framework • As mandated by 5th CAADP-PP in Abuja, the CAADP M&E framework will be validated in collaboration with AU/NEPAD and other stakeholders in South Africa between March 1 and 3, 2010
  • 11.
    Types of indicatorsand rationale • Input indicators: what is the overall level of effort invested? – CAADP processes, policies, institutions, investments, etc. • Output indicators: what is the level of provision, coverage, and utilization of services? – Access to infrastructure and services, adoption of technologies, etc. • Outcome indicators: what is the effect on outcomes that affect goals? – Yields, production, wages, prices, trade, etc. • Impact indicators: what is the ultimate effect on goals? – Growth, income, poverty, food security, hunger, etc. • Conditioning indicators: how confident are we that any observed changes is due to the intervention? – Total budgetary resources, climate, natural disasters, wars, etc. Page 11
  • 12.
    Input indicators: CAADP roundtable processIndicators: Program Key Program implementation scaling up and  Credible and relevant and M&E out, etc. evidence used in design of investment program National Focal Point appointed  Inclusive participation CAADP of stakeholders in Pillar 4 process Research & launched program design Technology Roundtable Pillar 3  Investment program conference Food security aligned with CAADP held & Steering & Pillar 2 Technical principles and targets compact Markets & trade signed Pillar 1 Committees  Investment program appointed Land & water technically reviewed management National compact  Mechanisms in place Cabinet memo developed & Stock taking discussed & for implementation and discussed and gap analysis approved M&E of the program completed Page 12
  • 13.
    Input indicators: enabling conditions (other processes, policies, institutions) Key Indicators: National Policy • Policies for private Gov’t Processes/Events Donors sector development CAADP, SWAP, MTEF, (property rights, access to Exp Reviews, Donor credit, contract enforcement, Private harmonization, licensing, competition, …) Others Sector Elections, Law, etc. • Policies on equity (access of poor and vulnerable groups to resources, markets, food, and nutrition) Regional Level Africa-wide level Global level • Governance (political Actors Process Actors Process Actors stability, accountability, Process government effectiveness, RECs, Reg Summit, AU, Int’l Assembly G-8, G-20, Conventi regulatory quality, rule of law, Orgs., etc. Reviews, Orgs., etc. , Summit, WTO, etc. ons, etc. control of corruption) etc. etc. • Harmonized policies and strategies • Commitments met Page 13
  • 14.
    Input indicators: investments and disaggregation CAADP Sub-sector Agriculture Pillar Crops, livestock, Research, extension, 1, 2, 3, 4 fishery, forestry irrigation, input support, markets, ... Commodity Staples, traditional, Sector AGRICULTURAL high value, export, ... Agriculture, roads, & RELATED education, health, Other INVESTMENTS water & sanitation, ... Gender, socio- economic groups Space Province, district, Source Economic rural/urban, Agro- Government, Salaries, capital, ecology Donors, Private operations and Sector maintenance, …
  • 15.
    Output indicators: coverage and utilization of services Investment / Provision / Utilization (e.g.) Disaggregation Intervention Coverage (e.g.) Research Number of Area under Commodity, gender, space technologies dev’d technology Extension Extension-farmer Number of visits Gender, space ratio received per year Irrigation Capacity of irrigation Area under irrigation Commodity, gender, space (irrigable area) Farm support Quantity of support Area under input Commodity, gender, space Feeder roads Length or density of Space roads Market Distance to nearest Share of output sold Commodity, gender, space market Post harvest Capacity of storage Capacity utilized Commodity, gender, space …
  • 16.
    Outcome indicators: agricultural sector performance Production, trade and prices Sector growth and by: contribution to Growth returns to overall GDP by: sub-sector, commodity, space different types of investments by: Space sub-sector, commodity, Sub-sector growth space AGRICULTURAL and contribution to SECTOR AgGDP by: Productivity of factors PERFORMANCE Space (land, labor, capital) and inputs by: Commodity growth, sub-sector, commodity, Use of factors (land, labor, contribution to gender, socio-economic capital) and inputs by: AgGDP by: group, space sub-sector, commodity, gender, Space socio-economic group, Space
  • 17.
    Impact indicators Unit costs by: Returns to different types of investments by: gender, socio- Distribution by: economic group, gender, socio-economic gender, socio- space group, space economic group, space Returns to sub-sector growth by: INCOME, gender, socio-economic POVERTY, Decomposition by: group, Space FOOD AND sector (agriculture, NUTRITION services, industry); sub- Returns to commodity sector (crops, livestock, growth by: SECURITY, fishery, forestry); HUNGER commodity (staples, gender, socio-economic group, Space high value, export, etc.)
  • 18.
    Implementation of CAADPM&E Framework • Implementation is a system consisting of: – Linked country level and regional teams, working under clearly defined roles and using shared data standards and protocols – Regular collection, documentation and processing of data at national and regional levels – Timely publication of these indicators and related monitoring reports
  • 19.
    Key indicators • Formal communications, declarations • Compact signings (country and regional) • Review and dialogue Processes • Mutual accountability framework • Levels and Shares • Sub-sector Agricultural • Spatial Investments Other factors: • Levels and growth rates trade, hunger, Agricultural • Production and Productivity inputs, prices, etc. Growth • Headcount index • Absolute numbers Poverty • MDG projections Reduction
  • 20.
    Overview of methodologyfor M&E Key question Tools Data Delivering on • Trends • National surveys commitments • Simple correlations • Expert opinion surveys Effectiveness of • Econometric methods • National surveys interventions • General equilibrium • Targeted surveys models • Expert opinion surveys Consistency • Simulation models • Assessment of effectiveness with initial • Participatory • Expert opinion surveys targets approaches Exploring better • Simulation models • Assessment of effectiveness interventions • Participatory and consistency approaches • Expert opinion surveys Details in (www.resakss.org/publications/DiscussionP4&7.pdf)
  • 21.
    Methodology: delivering on commitments • Trends, situation, and simple correlation analyses to monitor progress (i.e. no attribution to interventions) – CAADP Roundtable process – Donor commitments – 10% government agricultural expenditure – 6% agricultural GDP growth – Halving poverty and hunger, etc. • Data – National household surveys, accounts, etc. – International public datasets (AfDB, World Bank, FAO, etc.) – Targeted surveys (CAADP national focal points) – Targeted expert opinion surveys – … Page 21
  • 22.
    Methodology: effectiveness of interventions (1) • Main challenge is attribution • Two complementary approaches – Before and after treatment • Baselines (2003, compact signed, program implemented) • Mid-term, end of project, long after project – With and without treatment • Treatment: direct beneficiaries; indirect beneficiaries through information/technology transfers, etc. • Controls: can only be affected through general equilibrium effects, e.g. prices, wages, etc. • For poverty (pov), impact of intervention (INV) measured by Average Treatment effect of the Treated (ATT): ATTj = Ej [ povbefore, j – povafter, j | INVj =1] – Ei [povbefore, i – povafter, i | INVi =0] Page 22
  • 23.
    Methodology: effectiveness of interventions (2) • Underlying relationships to be estimated – Intervention decision making and placement – Household access to and utilization of services due to intervention – Household production, marketing and consumption decisions • Techniques – Econometric methods (double-difference, instrumental variables, matching) to assess direct impacts (mid-term, end of project, long after project) – General equilibrium modeling to assess economy-wide impacts • Data – National surveys – Targeted household, market and other surveys to fill gaps – Expert opinion surveys – Case studies (selected countries and/or programs) Page 23
  • 24.
    Methodology: consistency with initial targets • Apply models developed for stocktaking and gap analysis • What are the projected impacts if interventions proceed as planned? – Use mid-term estimated ex-post impacts and parameters and growth patterns to project ex-ante impacts over period when target is expected to be achieved  Are the projected impacts compatible with the CAADP targets? – Compare above ex-ante impacts with initial targets  If not, what adjustments are needed to get it on track? – Use data and information from experts to identify plausible scenarios – Simulate impacts under different scenarios to reach initial targets Page 24
  • 25.
    Methodology: exploring better interventions • Could greater or better distributed impacts be obtained by reconfiguring the interventions? – Even if interventions are consistent with the initial targets, can simulate impacts under different composition of investments to identify (in)efficiencies in implementation – Use estimated ex-post impacts and parameters from cross-country reviews and information from experts to identify plausible scenarios – Value of indicators associated with simulated impacts of the desirable scenarios can be used as guidelines to set new targets  What are the different interventions that can lead to these outcomes? – Composition of investments associated with desirable scenarios from preceding analysis Page 25
  • 26.
    Data collection strategy •Short-term: – Secondary sources – These are already collected, updated and made available on ReSAKSS website (www.resakss.org) • Medium-term: – ReSAKSS surveys and collection from country partners via regional nodes and established country SAKSS nodes • Already started in many countries and regions • Long-term: – ReSAKSS data collection mechanism institutionalized and implemented on regular basis (semi-annual, annual or bi-annual depending on indicator)
  • 27.
    Reporting and disseminationof M&E results • ReSAKSS Annual Trends Report and briefs to be completed by end of September of each year―timely for CAADP PP meeting • ReSAKSS website (www.resakss.org) to view and download trends, data, charts, supporting research publications, etc. • Various other media and presentations to review M&E information and results of analyses: – CAADP PP (Africa wide) – CAADP advisory councils (REC level) – ReSAKSS steering committee meetings (REC level) – Other regional- and country-level policy dialogues Page 27
  • 28.
    Tracking Progress ofCAADP: ReSAKSS Website www.resakss.org
  • 29.
    Users can customize the map and charts The ReSAKSS website allows based on the specific users to easily track progress information they are against looking for, whether the CAADP and MDG targets that be regional while also accessing a wealth of information or knowledge and data on country-specific agricultural development in information Africa
  • 30.
    Key collaborators • Themain collaborator at the country level will be the SAKSS nodes, which will liaise with the planning units of ministries, bureaus of statistics and private sector institutions and think tanks • Data quality will be guaranteed by working with partners such as the AU, NEPAD, RECs, CAADP Pillar institutions, CAADP country focal points, external partners such as UN institutions, Universities, etc • ReSAKSS will establish demonstrable agreements with RECs and national centers of expertise on shared platforms for benchmarking, collection…
  • 31.
    Roles and Responsibilitiesin Implementation of CAADP M&E Framework • Need for serious efforts by the RECs and their member countries to internalize the collection and provision of the data within their own M&E systems • This should be tied with serious efforts to meet International standards in reporting • Ultimately, the responsibility of collecting and analyzing the data and reporting the results must be with the country itself • ReSAKSS and network of partners can facilitate this – Consulting with the RECS and CAADP country focal points – Strengthening capacity of national statistical bureaus – …
  • 32.
    Results and Outputsof M&E System • Data collected are openly available for review, analysis and download on ReSAKSS website – 28 indicators already tracked and analyzed on website
  • 33.
    Results and Outputsof M&E System • Data are analyzed and published in key monitoring reports: – Annual Trends report for each node • Agriculture performance, investment and MDG targets – Semi-annual report on CAADP process that will be made available at each CAADP PP – Joint publications with key partners, such as AU/NEPAD
  • 34.
    Where are wenow? • Almost 7 years after CAADP, has there been any progress toward the goals? • The Process: – 13 countries and 1 region have signed CAADP compacts • Agricultural Spending/Investment: – The number of countries spending at least 10% of budgets on agriculture has increased since 2002 • Agricultural Growth: – At the continent level agricultural growth has increased since 2002 – The number of countries with annual agricultural growth rates of 6% or more has increased since 2002
  • 35.
    The National CAADPRoundtable Process & Country Status Zimbabwe, Cote d’Ivoire, Djibouti, Egypt, Comoros, Libya, Eritrea Seychelles Mauritius, DRC Madagascar, Sudan 2. REC and 3. Country Steering 1. Government 4. Cabinet Memo and Government launch and Technical appoints Focal Point(s) Endorsement process Committee 8. Elaboration of 5. Stocktaking, 7. Roundtable Signing 6. Drafting of Country detailed investment Growth, Invest. of Compact CAADP Compact plans Analysis Benin, Burundi, Cape Verde, Ethiopia, Burkina Faso, Guinea-Bissau, Gambia, Liberia, Mali, Niger, Ghana, Guinea, Kenya, Malawi, Nigeria, Sierra Leone, Senegal, Uganda, Zambia Togo Swaziland 10. Agreement on 11. Operational design 9. Post compact financing plan, and other technical review meeting and 12. Execution of new financing instruments, studies and validation of investment programs and annual review assessment for investment plans mechanism program execution Rwanda 14. Second annual 13. First annual review review meeting meeting
  • 36.
    Government spending onagriculture: Progress towards the Maputo Declaration target • The African continent as a whole has not met the 10% target (current spending at 6-8 percent) • But, this varies by country Only 8 countries have Agricultural Expenditures as a share of total (%), 2007 met the 10% 25 target 20 CURRENT, 2007 (Unless otherwise noted) 15 % 10 5 0 Central African… Madagascar** Ghana**** Guinea Bissau*** Morocco** Gabon*** Mali Nigeria DRC** Egypt** Swaziland** Benin**** Burundi*** Tunisia** Chad*** Kenya**** Uganda**** Tanzania** Malawi Sudan*** Zambia* Gambia*** Senegal Niger* Cote d'Ivoire Lesotho** Togo Mauritius** Namibia** Ethiopia** Rwanda Botswana Mauritania*** Mozambique** Guinea*** Cameroon** Zimbabwe** Burkina Faso* *=2006; **=2005; ***=2004; ****=2008 estimates Source: Omilola and Lambert, 2009.
  • 37.
    Have countries increasedtheir spending in response to the 2003 Maputo Declaration? • At the continental level, Level of agricultural spending as a share of total spending, 2002-2007 agricultural spending nearly doubled between 70.0% 2000 and 2005 60.0% % of reporting countries • In 2003, only 3.2% of countries allocated 10% 50.0% or more of their budgets 40.0% to agriculture – This increased to 33.3% 30.0% in 2006 before slightly falling to 25% in 2007 20.0% • 9 countries increased 10.0% their allocations from 0.0% less than 5% spending to 5-10% spending 2002 2003 2004 2005 2006 2007 Less than 5% 5%-10% More than 10% Source: Omilola and Lambert, 2009.
  • 38.
    Agricultural expenditure asa share of agricultural GDP • Measures government spending on agriculture relative to the size of that country's agriculture sector • Under this measure, more countries fall into the category of low budget support to agriculture Agricultural expenditures as a share of agricultural GDP, 2007 80 60 The range is CURRENT, 2007 (Unless otherwise noted) considerable % 40 (1 to 60%) 20 0 *=2006; **=2005; ***=2008 estimates On aggregate , Africa spends between 5-7% Source: Omilola and Lambert, 2009. of agricultural GDP on agriculture, compared to 15% in Asia during its Green Revolution
  • 39.
    -36 -30 -24 -18 -12 -6 12 18 24 0 6 Eritrea Gambia, The Zimbabwe Senegal Source: WDI Tunisia Mauritania 2008: Malawi Lesotho 2002: Cape Verde 6% CAADP target 6% CAADP target Gabon Mali Kenya Cote d'Ivoire Ethiopia Zambia Madagascar Algeria CAR Chad Guinea-Bissau Botswana DRC Seychelles Swaziland Niger Burkina Faso Djibouti Sudan Egypt Cameroon Page 39 Uganda Ghana Burundi Nigeria Comoros Mauritius Morocco Tanzania Agricultural GDP growth Guinea South Africa Togo Benin Namibia Only 9 countries achieved 6% or more annual growth At least 20 countries achieved 6% or more annual growth Mozambique Sao Tome &… Angola Rwanda Equatorial Guinea
  • 40.
    What about povertyand hunger? Burkina Faso Cameroon Congo, D.R. C. African Rep. Angola Ethiopia Botswana Guinea Algeria Egypt Kenya Malawi Ghana Mali Sao Tome and Principe Mauritania Morocco Tanzania Namibia Senegal Swaziland Togo Tunisia Uganda Countries on track towards Countries on track towards halving poverty by 2015 Only 6 Countries on track halving hunger by 2015 towards achieving both Source: Omilola and Lambert, 2009 goals of MDG1
  • 41.
    Next steps Formal validation of M&E framework by all stakeholders under the leadership of NEPAD and AU • Regional network already established • Next step is to fully operationalize country-level surveys and data analysis in each region – Establish country SAKSS nodes • Harmonize efforts with other development partners doing similar M&E work in Africa such as AGRA, World Bank, Pillar Institutions, Mutual Accountability Framework, etc • Track the contributions of the CAADP process to the achievements of agricultural growth and poverty reduction • Monitor how agricultural budgets are being spent • Establish critical M&E information needed to enhance effective dialogue and policy processes at all levels
  • 42.
