MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 1
DISSERTATION
On
“Medical Waste Management”
Submitted in partial fulfilment of the
Requirement for the award of degree of
Master of Architecture
Submitted by
Ishit Bharadwaj
M-Arch- 1st
sem
Medical Architecture
Guided by
Abdul Halim Babbu
FACULTY OF ARCHITECTURE & EKISTICS
JAMIA MILLIA ISLAMIA
NEW DELHI-110025
2013-2014
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 2
Department of Architecture
Faculty of Architecture & Ekistics,
Jamia Millia Islamia, New Delhi
Certificate
In the partial fulfilment of the M-Arch degree program, this is to certify that „Ishit
Bharadwaj‟ has worked on the Dissertation project entitled “Medical Waste
Management” under my guidance and supervision.
Abdul Halim Babbu Prof. S.M. Akhtar
Guide Dean
External Examiner 1 Abdul Halim Babbu
Head of Department
External Examiner 2
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 3
Declaration
I Ishit Bharadwaj hereby declare that the Dissertation entitled “Medical Waste
Management” submitted in the partial fulfilment of the requirements for the award of the degree
of Masters of Architecture is my original design/ research work and that the information taken from
secondary sources is given due citations and references.
[Signature]
Ishit Bharadwaj
Roll. No:
Date: M.Arch. Sem. - 1st
Place: 2013-14
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 4
Acknowledgment
At various stages in doing of thesis, a number of people have given me invaluable support.In this regard I
owe a depth of gratitude to my inspiration & guide Abdul Halim Babbu. Who have cultivated devotion
& determination in me & have been a helping hand at every moment to support & motivate me. I would
deeply thank To the Classmates for the systematic structuring the dissertation so as to make it an gradual
process of learning and application; for his regular evoking insightful discussions.
I am Grateful to My Parents, who kept ultimate faith in me & always provided me backup with their
love & best wishes.
Above all, I am highly grateful to God, who provided me such a golden opportunity, brilliant guidance,
& kind support. I would finally thank My Friends for the much needed pep talks and discussions and all
those who made this thesis come alive.
At last I beg pardon from all those who helped me but, my self-centered mind escaped their names
With Regards,
Ishit Bharadwaj
M-Arch – Ist sem
Medical Architecture
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 5
Abstract
Bio medical waste (BMW) collection and proper disposal has become a significant concern for both
the medical and general community. Effective management of biomedical waste is not only a legal
necessity but also a social responsibility.
A review of medical waste management systems was performed to understand (a) the various handling
and disposal procedures (b) the knowledge and awareness of individuals involved in medical waste
generation, handling and disposal, and (c) the potential impacts of the waste stream on both human health
and the natural environment. The purpose of the study is to provide direction for further study.
Information was collected mainly from literature review and online search. It was found that a variety of
methods were used by the medical facilities to dispose their wastes including burning, burial, entombing,
selling, dumping, and removal by municipal bins. The waste disposal practice was found to be quite
unsafe, and both clinical and non-clinical wastes were found to be thrown together. There was
insufficient awareness of the magnitude of the medical wastes issue by concerned individuals
At different levels, study showed that the hospital staff including high officials, and waste “haulers” was
not aware of the safe disposal and handling of hospital waste. Laboratory analysis showed severe
contamination of infectious wastes to the environment. Children, adults, and animals all have the
potential to come into contact with these wastes which may pose severe health risks to them. There was
no safety measure observed in dealing with waste disposal or laboratory analysis of infectious or
hazardous diseases. The chemicals used for the staining and preservation of slides and for the
sterilization and cleaning of equipment and surroundings are potentially harmful to the laboratory
technician and the environment. Hospital wastes pose a significant impact on health and environment.
From this study it can be said that there is an urgent need for raising awareness and education on medical
waste issues. Proper waste management strategy is needed to ensure health and environmental safety. For
further study, it is needed to collect more information on impacts, disposal and management to draw a
clear conclusion. Need to collect information and examples from developed country or the country,
which has sound medical waste management system. Find alternatives and appropriate technologies for
developing countries. Need extensive study on this medical waste and its management aspects as well.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 6
Table of Contents
1 SUMMARY..................................................................................................................................................10
1.1 INTRODUCTION..................................................................................................................................10
1.2 NEED OF THE STUDY ..........................................................................................................................10
1.3 AIMS AND OBJECTIVES.......................................................................................................................10
1.4 LIMITATIONS OF THE STUDY..............................................................................................................11
1.5 METHODOLOGY .................................................................................................................................11
2 INTRODUCTION..........................................................................................................................................12
2.1 MEDICAL WASTE................................................................................................................................12
2.2 NEED OF MEDICAL WASTE MANAGEMENT.......................................................................................12
2.3 FACTS AND FIGURES OF MEDICAL WASTE.........................................................................................13

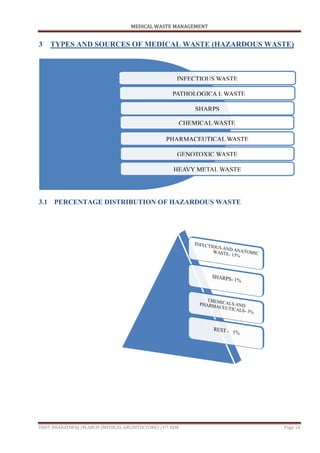

3 TYPES AND SOURCES OF MEDICAL WASTE (HAZARDOUS WASTE) ...........................................................14

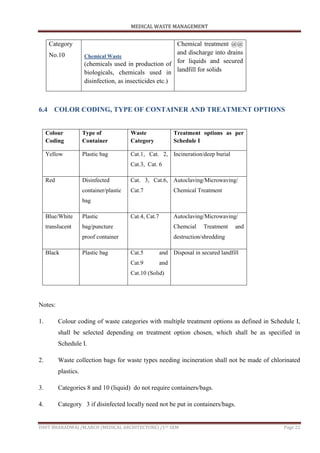

3.1 PERCENTAGE DISTRIBUTION OF HAZARDOUS WASTE ......................................................................14
3.2 DESCRIPTION OF DIFFERENT MEDICAL WASTE .................................................................................15
3.3 MAJOR SOURCES OF MEDICAL WASTE..............................................................................................15
4 INJURIES BY MEDICAL WASTE AND SOME EXAMPLES...............................................................................16
4.1 INJURIES OCCURRED IN PAST.............................................................................................................16
4.1.1 DUE TO SHARPS..........................................................................................................................16
4.1.2 DUE TO VACCINE WASTE ...........................................................................................................16
4.1.3 DUE TO RADIOACTIVE WASTE....................................................................................................16

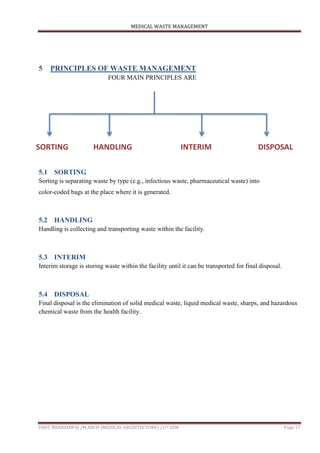

5 PRINCIPLES OF WASTE MANAGEMENT .....................................................................................................17
5.1 SORTING.............................................................................................................................................17
5.2 HANDLING..........................................................................................................................................17
5.3 INTERIM .............................................................................................................................................17
5.4 DISPOSAL............................................................................................................................................17

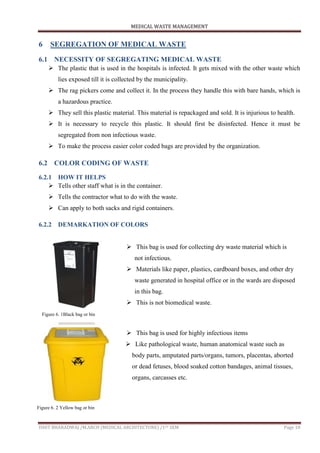

6 SEGREGATION OF MEDICAL WASTE ..........................................................................................................18
6.1 NECESSITY OF SEGREGATING MEDICAL WASTE ................................................................................18
6.2 COLOR CODING OF WASTE ................................................................................................................18
6.2.1 HOW IT HELPS............................................................................................................................18
6.2.2 DEMARKATION OF COLORS .......................................................................................................18

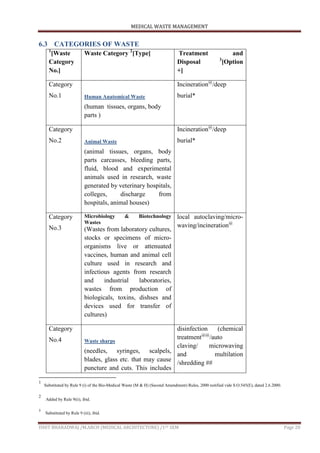

6.3 CATEGORIES OF WASTE .....................................................................................................................20
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 7
Human Anatomical Waste .................................................................................................................................20
Animal Waste.....................................................................................................................................................20
Waste sharps......................................................................................................................................................20
[Soiled] Waste....................................................................................................................................................21
Solid Waste ........................................................................................................................................................21
Liquid Waste ......................................................................................................................................................21
Incineration Ash.................................................................................................................................................21
Chemical Waste .................................................................................................................................................22
6.4 COLOR CODING, TYPE OF CONTAINER AND TREATMENT OPTIONS..................................................22
7 HANDLING AND TRANSPORT OF MEDICAL WASTE ...................................................................................23

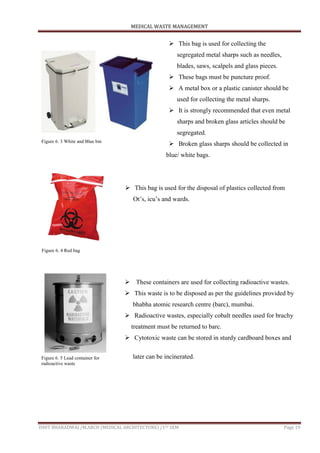

7.1 ON SITE TRANSPORT..........................................................................................................................23
7.2 OFF SITE TRANSPORT.........................................................................................................................23
7.3 BAG FILLIING ......................................................................................................................................23

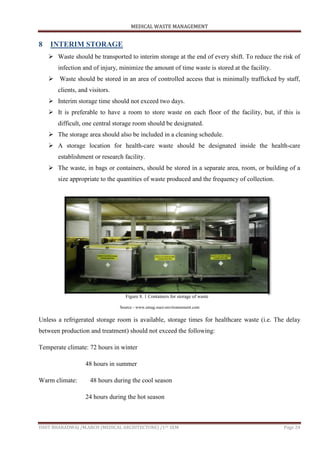

8 INTERIM STORAGE .....................................................................................................................................24
8.1 RECOMMENDATIONS FOR HOLDING WASTE IN HEALTH CARE FACILITIES.......................................25
9 SEGREGATION, PACKAGING, TRANSPORTATION AND STORAGE (A BRIEF IN ALL)...................................26
10 TREATMENT AND DISPOSAL ..................................................................................................................27

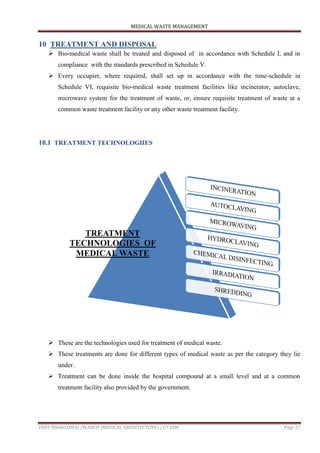

10.1 TREATMENT TECHNOLOGIIES............................................................................................................27
10.2 INCINERATION....................................................................................................................................28

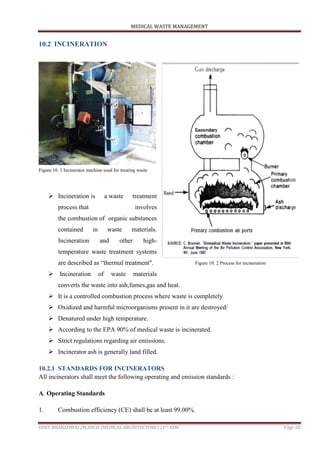

10.2.1 STANDARDS FOR INCINERATORS...............................................................................................28
10.3 AUTOCLAVING....................................................................................................................................30
10.3.1 STANDARDS FOR WASTE AUTOCLAVING...................................................................................31
10.4 MICROWAVING..................................................................................................................................32

10.4.1 STANDARDS FOR MICROWAVING..............................................................................................32

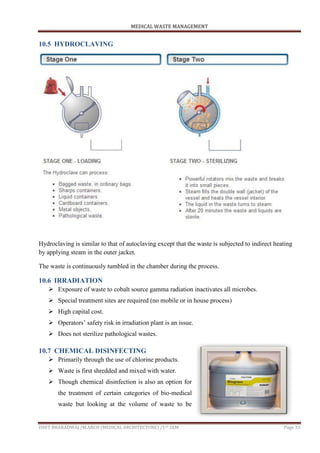

10.5 HYDROCLAVING .................................................................................................................................33
10.6 IRRADIATION......................................................................................................................................33
10.7 CHEMICAL DISINFECTING...................................................................................................................33
10.7.1 STANDARDS FOR LIQUID WASTE ...............................................................................................34
10.8 SHREDDING........................................................................................................................................34
10.8.1 STANDARDS FOR DEEP BURIAL..................................................................................................34
11 SAFETY MEASURES WHILE HANDLING MEDICAL WASTE ......................................................................35

11.1 HAZARDOUS CHEMICAL WASTE ........................................................................................................35
11.2 DISPOSAL OF USED SYRINGES............................................................................................................35
11.3 SAFE SHARPS DISPOSAL .....................................................................................................................35
11.3.1 SHARPS CONTAINER DISPOSAL CRITERIA ..................................................................................35
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 8
11.4 DISPOSAL OF LABORATORIES SPECIMENS.........................................................................................36
11.5 MANAGEMENT OF USED LENIN.........................................................................................................36
11.6 MANAGEMENT OF REUSABLE INSTRUMENT.....................................................................................36
12 PRESCRIBED AUTHORITY FOR MEDICAL WASTE MANAGEMENT..........................................................36
13 AUTHORISATION AUTHORITIES OF MEDICAL WASTE............................................................................38
14 MAINTAINANCE OF RECORDS................................................................................................................38
15 GUIDELINES BY CPCB FOR MEDICAL WASTE TREATMENT PLANT .........................................................38
15.1 LOCATION OF A CBWTF .....................................................................................................................39
15.2 LAND REQUIREMENT .........................................................................................................................39
15.3 COVERAGE AREA OF CBWTF..............................................................................................................39
16 CONCLUSION AND RECOMMENDATION ...............................................................................................40
16.1 RECOMMENDATION ..........................................................................................................................40
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 9
List of Figures
Figure 7. 1 Trolley used for transport of waste....................................................................................23
Figure 7. 2 Sign of bio hazard waste at bags .......................................................................................23
Figure 8. 1 Containers for storage of waste .........................................................................................24
Figure 8. 2 Container for infectious waste...........................................................................................25
Figure 10. 1 Incinerator machine used for treating waste....................................................................28
Figure 10. 2 Process for incineration ...................................................................................................28
Figure 10. 3 Autoclave machine ..........................................................................................................30
Figure 10. 4 An autoclaving unit .........................................................................................................30
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 10
1 SUMMARY
1.1 INTRODUCTION
Medical waste or clinical waste refers to the waste that is generated by health care premises such as
hospitals , clinics , doctor‟s offices , veterinary hospitals and labs and is cannot be considered as
general waste.
1.2 NEED OF THE STUDY
Poor management of health care waste potentially exposes health care workers, waste handlers,
patients and the community at large to infection, toxic effects and injuries, and risks polluting the
environment.
So, it is essential that all medical waste materials are segregated at the point of generation,
appropriately treated and disposed of safely.
1.3 AIMS AND OBJECTIVES
 The basic aim is to protect the public and the environment from potentially infectious
diseases caused due to lack of management of medical waste.
 To find out the types of wastes produced by the hospital and how much it is affecting the
living animals i.e. humans or animals.
 To find out the linkages between the clean area and dirty area in the hospital.
 To find out how the waste is segregated at its generation point, how it is treated inside a
hospital compound and how it is disposed.
 To find out the awareness of waste management amongst the hospital staff.
 The objective of this study is to safeguard the lives of humans, animals or plants from any
disease.
 To cut down the risk of cutting and edging of waste handlers.
 To prevent the use of used products such as syringes which is a major cause to communicate
any disease.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 11
1.4 LIMITATIONS OF THE STUDY
 This study will not deal with the technical issues regarding the treatment of medical waste.
 The diseases caused due to the poor waste management will be briefly discussed not will be
fully elaborated.
1.5 METHODOLOGY
 The study will be based on the information provided on the internet and architecture journals
or magazines.
 Information from case study of different hospitals will also be mentioned.
 Interaction with the related people will also be done to do a better research.
 Interaction with the hospital staff will also be done to know the awareness of waste
management among them.
 To frame out certain guidelines which would help in management of medical waste in a
better way and to preserve the environment and lives from its adverse effects.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 12
2 INTRODUCTION
2.1 MEDICAL WASTE
Medical waste means any solid and/or liquid waste including its container and any intermediate
product, which is generated during the diagnosis, treatment or immunization of human beings or
animals or in research or in the production or testing.
OR
Any waste which consists entirely or partly of human or animal tissue, blood or other body fluids,
excretions, drugs or other pharmaceutical products, dressings or syringes, needles or other sharp
instruments.
Medical waste includes all infectious waste,
hazardous (including low-level radioactive
wastes), and any other wastes that are generated
from all types of health care institutions,
including hospitals, clinics, doctor‟s (including
dental and veterinary) offices and medical
laboratories.
2.2 NEED OF MEDICAL WASTE MANAGEMENT
Poor management of health care waste potentially
exposes health care workers, waste handlers,
patients and the community at large to infection,
toxic effects and injuries, and risks polluting the
environment.
Health-care waste contains harmful micro-
organisms which can infect hospital patients,
health-care workers and the general public
Other potential infectious risks may include the
spread of drug-resistant micro-organisms from health-care establishments into the environment.
Figure2. 1 Medical waste of several types
Figure2. 2 Inappropriate disposal of waste
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 13
Medical waste can potentially be re used without
sterilization, this reuse of non-sterile waste
material poses a serious threat of the diseases.
It may also damage the environment (e.g.
,contamination of water, air, and food).in
addition, if waste is not disposed off properly,
members of the community may have an
opportunity to collect disposable medical items
(particularly syringes) and to re pack and sell
these materials..
2.3 FACTS AND FIGURES OF MEDICAL WASTE
 Of the total medical waste 80% is the general waste which can be comparable to domestic
waste.
 The remaining 20% is considered hazardous which may be infectious, toxic or radioactive.
 High-income countries generate on average up to 0.5 kg of hazardous waste per bed per day.
 While low-income countries generate on average 0.2 kg of hazardous waste per bed per day.
 However, health-care waste is often not separated into hazardous or non-hazardous wastes in
low-income countries making the real quantity of hazardous waste much higher.
Figure2.3 Rag picker collecting useful materials from waste
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 14
3 TYPES AND SOURCES OF MEDICAL WASTE (HAZARDOUS WASTE)
3.1 PERCENTAGE DISTRIBUTION OF HAZARDOUS WASTE
INFECTIOUS WASTE
PATHOLOGICA L WASTE
SHARPS
CHEMICAL WASTE
PHARMACEUTICAL WASTE
GENOTOXIC WASTE
HEAVY METAL WASTE
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 15
3.2 DESCRIPTION OF DIFFERENT MEDICAL WASTE
Infectious waste: waste contaminated with blood and its by-products, cultures and stocks of
infectious agents, waste from patients in isolation wards, discarded diagnostic
samples containing blood and body fluids, infected animals from laboratories,
and contaminated materials (swabs, bandages) and equipment (such as
disposable medical devices).
Pathological waste: recognizable body parts and contaminated animal car cases.
Sharps: syringes, needles, disposable scalpels and blades, etc.
Chemical waste: for example mercury, solvents and disinfectants.
Pharmaceuticals: expired, unused, and contaminated drugs; vaccines and sera.
Genotoxic waste: highly hazardous, mutagenic, teratogenic1 or carcinogenic, such as cytotoxic
drugs used in cancer treatment and their metabolites.
Radioactive waste: such as glassware contaminated with radioactive diagnostic material or radio
therapeutic materials.
Heavy metals waste: such as broken mercury thermometers.
3.3 MAJOR SOURCES OF MEDICAL WASTE
 Hospitals and other health-care establishments.
 Laboratories and research centres.
 Mortuary and autopsy centres.
 Animal research and testing laboratories
 Blood banks and collection services
 Nursing homes for the elderly.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 16
4 INJURIES BY MEDICAL WASTE AND SOME EXAMPLES
 Radiation burns;
 Sharps-inflicted injuries;
 Poisoning and pollution through the
release of pharmaceutical products, in
particular, antibiotics and cytotoxic drugs;
 Poisoning and pollution through waste
water;
 Poisoning and pollution by toxic elements
or compounds, such as mercury or
dioxins that are released during
incineration.
4.1 INJURIES OCCURRED IN PAST
4.1.1 DUE TO SHARPS
Who estimated that, in 2000, injections with contaminated syringes caused 21
million hepatitis b virus (hbv) infections, two million hepatitis c virus infections
and 260 000 hiv infections worldwide. Many of these infections were avoidable if
the syringes had been disposed of safely.
4.1.2 DUE TO VACCINE WASTE
In june 2000 six children were diagnosed with a mild form of smallpox (vaccinia
virus) after having played with glass ampoules containing expired smallpox
vaccine at a garbage dump in vladivostok (russia).
4.1.3 DUE TO RADIOACTIVE WASTE
Serious accidents have been documented in brazil in 1988 (where four people died
and 28 had serious radiation burns), mexico and morocco in 1983, algeria in 1978
and mexico in 1962.
Figure 4.1 Burial of medical waste in open environment
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 17
5 PRINCIPLES OF WASTE MANAGEMENT
FOUR MAIN PRINCIPLES ARE
5.1 SORTING
Sorting is separating waste by type (e.g., infectious waste, pharmaceutical waste) into
color-coded bags at the place where it is generated.
5.2 HANDLING
Handling is collecting and transporting waste within the facility.
5.3 INTERIM
Interim storage is storing waste within the facility until it can be transported for final disposal.
5.4 DISPOSAL
Final disposal is the elimination of solid medical waste, liquid medical waste, sharps, and hazardous
chemical waste from the health facility.
SORTING HANDLING INTERIM
STORAGE
DISPOSAL
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 18
6 SEGREGATION OF MEDICAL WASTE
6.1 NECESSITY OF SEGREGATING MEDICAL WASTE
 The plastic that is used in the hospitals is infected. It gets mixed with the other waste which
lies exposed till it is collected by the municipality.
 The rag pickers come and collect it. In the process they handle this with bare hands, which is
a hazardous practice.
 They sell this plastic material. This material is repackaged and sold. It is injurious to health.
 It is necessary to recycle this plastic. It should first be disinfected. Hence it must be
segregated from non infectious waste.
 To make the process easier color coded bags are provided by the organization.
6.2 COLOR CODING OF WASTE
6.2.1 HOW IT HELPS
 Tells other staff what is in the container.
 Tells the contractor what to do with the waste.
 Can apply to both sacks and rigid containers.
6.2.2 DEMARKATION OF COLORS
 This bag is used for collecting dry waste material which is
not infectious.
 Materials like paper, plastics, cardboard boxes, and other dry
waste generated in hospital office or in the wards are disposed
in this bag.
 This is not biomedical waste.
 This bag is used for highly infectious items
 Like pathological waste, human anatomical waste such as
body parts, amputated parts/organs, tumors, placentas, aborted
or dead fetuses, blood soaked cotton bandages, animal tissues,
organs, carcasses etc.
Figure 6. 1Black bag or bin
Figure 6. 2 Yellow bag or bin
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 19
 This bag is used for collecting the
segregated metal sharps such as needles,
blades, saws, scalpels and glass pieces.
 These bags must be puncture proof.
 A metal box or a plastic canister should be
used for collecting the metal sharps.
 It is strongly recommended that even metal
sharps and broken glass articles should be
segregated.
 Broken glass sharps should be collected in
blue/ white bags.
 This bag is used for the disposal of plastics collected from
Ot‟s, icu‟s and wards.
 These containers are used for collecting radioactive wastes.
 This waste is to be disposed as per the guidelines provided by
bhabha atomic research centre (barc), mumbai.
 Radioactive wastes, especially cobalt needles used for brachy
treatment must be returned to barc.
 Cytotoxic waste can be stored in sturdy cardboard boxes and
later can be incinerated.
Figure 6. 3 White and Blue bin
Figure 6. 4 Red bag
Figure 6. 5 Lead container for
radioactive waste
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 20
6.3 CATEGORIES OF WASTE
1
[Waste
Category
No.]
Waste Category 2
[Type] Treatment and
Disposal 3
[Option
+]
Category
No.1 Human Anatomical Waste
(human tissues, organs, body
parts )
Incineration@
/deep
burial*
Category
No.2 Animal Waste
(animal tissues, organs, body
parts carcasses, bleeding parts,
fluid, blood and experimental
animals used in research, waste
generated by veterinary hospitals,
colleges, discharge from
hospitals, animal houses)
Incineration@
/deep
burial*
Category
No.3
Microbiology & Biotechnology
Wastes
(Wastes from laboratory cultures,
stocks or specimens of micro-
organisms live or attenuated
vaccines, human and animal cell
culture used in research and
infectious agents from research
and industrial laboratories,
wastes from production of
biologicals, toxins, dishses and
devices used for transfer of
cultures)
local autoclaving/micro-
waving/incineration@
Category
No.4 Waste sharps
(needles, syringes, scalpels,
blades, glass etc. that may cause
puncture and cuts. This includes
disinfection (chemical
treatment@@
/auto
claving/ microwaving
and multilation
/shredding ##
1
Substituted by Rule 9 (i) of the Bio-Medical Waste (M & H) (Second Amendment) Rules, 2000 notified vide S.O.545(E), dated 2.6.2000.
2
Added by Rule 9(ii), ibid.
3
Substituted by Rule 9 (iii), ibid.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 21
both used and unused sharps)
Category
No.5
Discarded Medicines and Cytotoxic
drugs
(wastes comprising of outdated,
contaminated and discarded
medicines)
incineration@
/destruction
and drugs disposal in
secured landfills
Category
No.6 4
[Soiled] Waste
(Items contaminated with blood,
and body fluids including cotton,
dressings, soiled plaster casts,
lines beddings, other material
contaminated with blood)
incineration @
autoclaving/microwaving
Category
No.7 Solid Waste
(wastes generated from
disposable items other than the
waste 5
[sharps] such as tubings,
catheters, intravenous sets etc.)
disinfection by chemical
treatment@@
autoclaving/
microwaving and
mutilation/shredding##
Category
No.8 Liquid Waste
(waste generated from laboratory
and washing, cleaning, house-
keeping and disinfecting
activities)
disinfection by chemical
treatment @@ and
discharge into drains.
Category
No.9 Incineration Ash
(ash from incineration of any
bio-medical waste)
disposal in municipal
landfill
4
Substituted by rule 9(iv), ibid.
5
Substituted by Rule 9 (v) of the Bio-Medical Waste (M & H) (Second Amendment) Rules, 2000 notified vide S.O.545(E), dated 2.6.2000.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 22
Category
No.10 Chemical Waste
(chemicals used in production of
biologicals, chemicals used in
disinfection, as insecticides etc.)
Chemical treatment @@
and discharge into drains
for liquids and secured
landfill for solids
6.4 COLOR CODING, TYPE OF CONTAINER AND TREATMENT OPTIONS
Colour
Coding
Type of
Container
Waste
Category
Treatment options as per
Schedule I
Yellow Plastic bag Cat.1, Cat. 2,
Cat.3, Cat. 6
Incineration/deep burial
Red Disinfected
container/plastic
bag
Cat. 3, Cat.6,
Cat.7
Autoclaving/Microwaving/
Chemical Treatment
Blue/White
translucent
Plastic
bag/puncture
proof container
Cat.4, Cat.7 Autoclaving/Microwaving/
Chemcial Treatment and
destruction/shredding
Black Plastic bag Cat.5 and
Cat.9 and
Cat.10 (Solid)
Disposal in secured landfill
Notes:
1. Colour coding of waste categories with multiple treatment options as defined in Schedule I,
shall be selected depending on treatment option chosen, which shall be as specified in
Schedule I.
2. Waste collection bags for waste types needing incineration shall not be made of chlorinated
plastics.
3. Categories 8 and 10 (liquid) do not require containers/bags.
4. Category 3 if disinfected locally need not be put in containers/bags.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 23
7 HANDLING AND TRANSPORT OF MEDICAL WASTE
 Medical waste should be handled as little as possible before disposal.
 It should not be collected from patient-care areas by emptying into open carts; this may lead
to contamination of the surroundings and to scavenging of waste as well as to an increased
risk of injury to staff, clients and visitors.
7.1 ON SITE TRANSPORT
Health-care waste should be transported within the hospital
or other facility by means of wheeled trolleys, containers,
or carts that are not used for any other purpose and meet
the following specifications:
 Easy to load and unload;
 No sharp edges that could damage waste bags or
containers during loading and unloading;
 Easy to clean
The vehicles should be cleaned and disinfected daily with
an appropriate disinfectant.
Different colored bags have to be segregated in the storage room.
7.2 OFF SITE TRANSPORT
 Waste should be arranged by concerned municipal / local authority.
 The waste should be transferred to the vehicle by sanitary worker under the supervision of
WMO.
7.3 BAG FILLIING
 Waste and sharps containers should be discarded
when they become three quarters full and at least
once daily or after each shift.
 The reason for this is to reduce the risk of plastic
bags splitting open and of an injury from a protruding
sharp item in sharps containers.
Figure 7. 1 Trolley used for transport of waste
Figure 7. 2 Sign of bio hazard waste at bags
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 24
8 INTERIM STORAGE
 Waste should be transported to interim storage at the end of every shift. To reduce the risk of
infection and of injury, minimize the amount of time waste is stored at the facility.
 Waste should be stored in an area of controlled access that is minimally trafficked by staff,
clients, and visitors.
 Interim storage time should not exceed two days.
 It is preferable to have a room to store waste on each floor of the facility, but, if this is
difficult, one central storage room should be designated.
 The storage area should also be included in a cleaning schedule.
 A storage location for health-care waste should be designated inside the health-care
establishment or research facility.
 The waste, in bags or containers, should be stored in a separate area, room, or building of a
size appropriate to the quantities of waste produced and the frequency of collection.
Source - www.emag.suez-environnement.com
Unless a refrigerated storage room is available, storage times for healthcare waste (i.e. The delay
between production and treatment) should not exceed the following:
Temperate climate: 72 hours in winter
48 hours in summer
Warm climate: 48 hours during the cool season
24 hours during the hot season
Figure 8. 1 Containers for storage of waste
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 25
Cytotoxic waste
 Should be stored separately from other health-care waste in a designated secure location.
Radioactive waste
 Should be stored in containers that
prevent dispersion, behind lead
shielding.
 Waste that is to be stored during
radioactive decay should be labelled
with the type of radionuclide, the date,
and details of required storage
conditions.
8.1 RECOMMENDATIONS FOR HOLDING WASTE IN HEALTH CARE
FACILITIES
 The storage area should have an impermeable, hard-standing floor with good drainage; it
should be easy to clean and disinfect.
 There should be a water supply for cleaning purposes.
 The storage area should afford easy access for staff in charge of handling the waste.
 It should be possible to lock the store to prevent access by unauthorized persons.
 Easy access for waste-collection vehicles is essential.
 There should be protection from the sun.
 The storage area should be inaccessible for animals, insects, and birds.
 There should be good lighting and at least passive ventilation.
 The storage area should not be situated in the proximity of fresh food stores or food
preparation areas.
 A supply of cleaning equipment, protective clothing, and waste bags or containers should be
located conveniently close to the storage area.
Figure 8. 2 Container for infectious waste
Source - www.emag.suez-environnement.com
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 26
9 SEGREGATION, PACKAGING, TRANSPORTATION AND STORAGE
(A BRIEF IN ALL)
 Bio-medical waste shall not be mixed with other wastes.
 Bio-medical waste shall be segregated into containers/bags at the point of generation in
accordance with Schedule II prior to its storage, transportation, treatment and disposal. The
containers shall be labeled according to Schedule III.
 If a container is transported from the premises where bio-medical waste is generated to any
waste treatment facility outside the premises, the container shall, apart from the label
prescribed in Schedule III, also carry information prescribed in Schedule IV.
 Notwithstanding anything contained in the Motor Vehicles Act, 1988, or rules thereunder,
untreated bio-medical waste shall be transported only in such vehicle as may be authorised
for the purpose by the competent authority as specified by the Government.
 No untreated bio-medical waste shall be kept stored beyond a period of 48 hours :
provided that if for any reason it becomes necessary to store the waste beyond such period,
the authorised person must take permission of the prescribed authority and take measures to
ensure that the waste does not adversely affect human health and the environment.
 6[(6)The Municipal body of the area shall continue to pick up and transport segregated non
bio-medical solid waste generated in hospitals and nursing homes, as well as duly treated bio-
medical wastes for disposal at municipal dump site].
6
Inserted by Rule 3 of the Bio-Medical Waste (M & H) (Second Amendment) Rules, 2000 vide notification S.O.545(E), dated 2.6.2000.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 27
10 TREATMENT AND DISPOSAL
 Bio-medical waste shall be treated and disposed of in accordance with Schedule I, and in
compliance with the standards prescribed in Schedule V.
 Every occupier, where required, shall set up in accordance with the time-schedule in
Schedule VI, requisite bio-medical waste treatment facilities like incinerator, autoclave,
microwave system for the treatment of waste, or, ensure requisite treatment of waste at a
common waste treatment facility or any other waste treatment facility.
10.1 TREATMENT TECHNOLOGIIES
 These are the technologies used for treatment of medical waste.
 These treatments are done for different types of medical waste as per the category they lie
under.
 Treatment can be done inside the hospital compound at a small level and at a common
treatment facility also provided by the government.
TREATMENT
TECHNOLOGIES OF
MEDICAL WASTE
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 28
10.2 INCINERATION
 Incineration is a waste treatment
process that involves
the combustion of organic substances
contained in waste materials.
Incineration and other high-
temperature waste treatment systems
are described as “thermal treatment".
 Incineration of waste materials
converts the waste into ash,fumes,gas and heat.
 It is a controlled combustion process where waste is completely
 Oxidized and harmful microorganisms present in it are destroyed/
 Denatured under high temperature.
 According to the EPA 90% of medical waste is incinerated.
 Strict regulations regarding air emissions.
 Incinerator ash is generally land filled.
10.2.1 STANDARDS FOR INCINERATORS
All incinerators shall meet the following operating and emission standards :
A. Operating Standards
1. Combustion efficiency (CE) shall be at least 99.00%.
Figure 10. 1 Incinerator machine used for treating waste
Figure 10. 2 Process for incineration
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 29
2. The Combustion efficiency is computed as follows :
%CO2
C.E. =____________________ x 100
% CO2+ % CO
The temperature of the primary chamber shall be 800 ± 50co
.
The secondary chamber gas residence time shall be at least 1 (one) second at 1050 ± 50co
, with
minimum 3% Oxygen in the stack gas.
B. Emission Standards
Parameters Concentration mg/Nm3
at (12% CO2 correction)
(1) Particulate matter 150
(2) Nitrogen Oxides 450
(3) HCl 50
(4) Minimum stack height shall be 30 metres above ground.
(5) Volatile organic compounds in ash shall not be more than 0.01%.
Note :
Suitably designed pollution control devices should be installed/retrofitted with the incinerator to
achieve the above emission limits, if necessary.
Wastes to be incinerated shall not be chemically treated with any chlorinated disinfectants.
Chlorinated plastics shall not be incinerated.
Toxic metals in incineration ash shall be limited within the regulatory quantities as defined under the
Hazardous Waste (Management and Handling ) Rules, 1989.
Only low sulphur fuel like L.D.O./L.S.H.S./Diesel shall be used as fuel in the incinerator.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 30

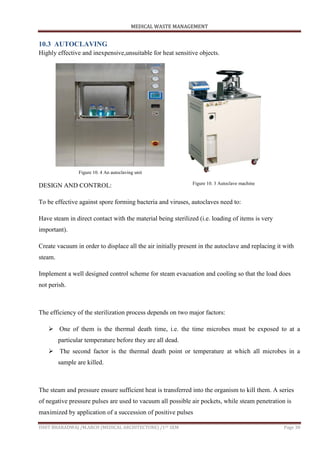

10.3 AUTOCLAVING
Highly effective and inexpensive,unsuitable for heat sensitive objects.
DESIGN AND CONTROL:
To be effective against spore forming bacteria and viruses, autoclaves need to:
Have steam in direct contact with the material being sterilized (i.e. loading of items is very
important).
Create vacuum in order to displace all the air initially present in the autoclave and replacing it with
steam.
Implement a well designed control scheme for steam evacuation and cooling so that the load does
not perish.
The efficiency of the sterilization process depends on two major factors:
 One of them is the thermal death time, i.e. the time microbes must be exposed to at a
particular temperature before they are all dead.
 The second factor is the thermal death point or temperature at which all microbes in a
sample are killed.
The steam and pressure ensure sufficient heat is transferred into the organism to kill them. A series
of negative pressure pulses are used to vacuum all possible air pockets, while steam penetration is
maximized by application of a succession of positive pulses
Figure 10. 4 An autoclaving unit
Figure 10. 3 Autoclave machine
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 31
 Autoclaving is a low-heat thermal process where steam is brought into direct contact with
waste in a controlled manner and for sufficient duration to disinfect the wastes.
 For ease and safety in operation, the system should be horizontal type and exclusively
designed for the treatment of bio-medical waste.
 Often followed by compaction process, and eventually reaches landfills.
10.3.1 STANDARDS FOR WASTE AUTOCLAVING
The autoclave should be dedicated for the purposes of disinfecting and treating bio-medical waste,
(I) When operating a gravity flow autoclave, medical waste shall be subjected to :
(i) a temperature of not less than 121o
C and pressure of 15 pounds per square inch (psi) for an
autoclave residence time of not less than 60 minutes; or
(ii) a temperature of not less than 135o
C and a pressure of 31 psi for an autoclave residence time
of not less than 45 minutes; or
(iii) a temperature of not less than 149o
C and a pressure of 52 psi for an autoclave residence time
of not less than 30 minutes.
(II) When operating a vacuum autoclave, medical waste shall be subjected to a minimum of one
pre-vacuum pulse to purge the autoclave of all air. The waste shall be subjected to the following :
a temperature of not less than 121o
C and pressure of 15 psi per an autoclave residence time of not
less than 45 minutes ; or
(ii) a temperature of not less than 135o
C and a pressure of 31 psi for an autoclave residence time
of not less than 30 minutes;
(III) Medical waste shall not be considered properly treated unless the time, temperature and
pressure indicators indicate that the required time, temperature and pressure were reached during the
autoclave process. If for any reasons, time temperature or pressure indicator indicates that the
required temperature, pressure or residence time was not reached , the entire load of medical waste
must be autoclaved again until the proper temperature, pressure and residence time were achieved.
(IV) Recording of operational parameters
Each autoclave shall have graphic or computer recording devices which will automatically and
continuously monitor and record dates, time of day, load identification number and operating
parameters throughout the entire length of the autoclave cycle.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 32
(V) Validation test
Spore testing :
The autoclave should completely and consistently kill approved biological indicator at the maximum
design capacity of each autoclave unit. Biological indicator for autoclave shall be Bacillus
stearothermophilus spores using vials or spore strips, with at least 1x104
spores per millilitre. Under
no circumstances will an autoclave have minimum operating parameters less than a residence time of
30 minutes, regardless of temperature and pressure, a temperature less than 121o
C or a pressure less
than 15 psi.
(VI) Routine Test
A chemical indicator strip/tape that changes colour when a certain temperature is reached can be
used to verify that a specific temperature has been achieved. It may be necessary to use more than
one strip one strip over the waste package at different location to ensure that the inner content of the
package has been adequately autoclaved.
10.4 MICROWAVING
 In microwaving, microbial inactivation occurs as a result of the thermal effect of
electromagnetic radiation spectrum lying between the frequencies 300 and 300,000 mhz.
 The heating occurs inside the waste material in the presence of steam.
10.4.1 STANDARDS FOR MICROWAVING
1. Microwave treatment shall not be used for cytotoxic, hazardous or radioactive wastes,
contaminated animal carcasses, body parts and large metal items.
2. The microwave system shall comply with the efficacy test/routine tests and a performance
guarantee may be provided by the supplier before operation of the unit.
3. The microwave should completely and consistently kill the bacteria and other pathogenic
organisms that is ensured by approved bio-logical indicator at the maximum design capacity of each
microwave unit. Biological indicators for microwave shall be Bacillus Subtilis spores using vials or
spore strips with at least 1x104
spores per milliliter.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 33
10.5 HYDROCLAVING
Hydroclaving is similar to that of autoclaving except that the waste is subjected to indirect heating
by applying steam in the outer jacket.
The waste is continuously tumbled in the chamber during the process.
10.6 IRRADIATION
 Exposure of waste to cobalt source gamma radiation inactivates all microbes.
 Special treatment sites are required (no mobile or in house process)
 High capital cost.
 Operators‟ safety risk in irradiation plant is an issue.
 Does not sterilize pathological wastes.
10.7 CHEMICAL DISINFECTING
 Primarily through the use of chlorine products.
 Waste is first shredded and mixed with water.
 Though chemical disinfection is also an option for
the treatment of certain categories of bio-medical
waste but looking at the volume of waste to be
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 34
disinfected at the cbwtf and the pollution load associated with the use of disinfectants,
 The use of chemical disinfection for the treatment of bio-medical waste at cbwtf is not
recommended.
10.7.1 STANDARDS FOR LIQUID WASTE
The effluent generated from the hospital should conform to the following limits :
PARAMETERS PERMISSIBLE LIMITS
pH 6.5-9.0
Suspended solids 100 mg/1
Oil and grease 10 mg/1
BOD 30 mg/1
COD 250 mg/1
Bio-assay test 90% survival of fish after 96 hours in 100% effluent
These limits are applicable to those hospitals which are either connected with sewers without
terminal sewage treatment plant or not connected to public sewers. For discharge into public sewers
with terminal facilities, the general standards as notified under the Environment (Protection) Act,
1986 shall be applicable.
10.8 SHREDDING
Shredding is a process by which waste are deshaped or cut into smaller pieces so as to make the
wastes unrecognizable.
It helps in prevention of reuse of bio-medical waste and also acts as identifier that the waste have
been disinfected and are safe to dispose off.
10.8.1 STANDARDS FOR DEEP BURIAL
 A pit or trench should be dug about 2 metres deep. It should be half filled with waste, then
covered with lime within 50 cm of the surface, before filling the rest of the pit with soil.
 It must be ensured that animals do not have any access to burial sites. Covers of galvanized
iron/wire meshes may be used.
 On each occasion, when wastes are added to the pit, a layer of 10 cm of soil shall be added
to cover the wastes.
 Burial must be performed under close and dedicated supervision.
 The deep burial site should be relatively impermeable and no shallow well should be close to
the site.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 35
 The pits should be distant from habitation, and sited so as to ensure that no contamination
occurs of any surface water or groundwater. The area should not be prone to flooding or
erosion.
 The location of the deep burial site will be authorized by the prescribed authority.
 The institution shall maintain a record of all pits for deep burial.
11 SAFETY MEASURES WHILE HANDLING MEDICAL WASTE
11.1 HAZARDOUS CHEMICAL WASTE
 Always wear heavy utility gloves and shoes when handling or transporting hazardous
chemical waste.
 Afterwards, wash both gloves and shoes if
they become contaminated.
 Cleaning solutions and disinfectants should be
handled as liquid medical waste.
 After disposal, rinse containers thoroughly
with water, wash glass containers with
detergent and water.
 Do not reuse plastic containers.
 Disposing of cytotoxic and radioactive waste should be done in accordance with all local and
national laws and regulations.
11.2 DISPOSAL OF USED SYRINGES
Place all used syringes in designated sharps container and never recap needles.
11.3 SAFE SHARPS DISPOSAL
Never discard needles and sharps in clinical waste bags, as the
housekeeping staff might get injured.
11.3.1 SHARPS CONTAINER DISPOSAL CRITERIA
There are four major criteria for sharps disposal container safety
performance:
Functionality, Accessibility, Visibility & Accommodation:
Functionality: Containers should remain in a good state during
their entire usage. They should
be leak resistant on their sides and bottoms and puncture resistant
until final disposal. Individual
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 36
containers should have adequate volume and safe access to the opening.
Accessibility: Containers should be accessible to all workers who use, maintain, or dispose off sharp
devices. Containers should be placed in all areas where sharps are used and, if necessary, portable
within the workplace.
Visibility: Containers should be visible to the workers who use them. Workers should be
able to see the degree to which the container is full (for plastic containers only).
Accommodation: Container designs should be convenient, environmentally sound, and easy to
store.
11.4 DISPOSAL OF LABORATORIES SPECIMENS
All laboratory specimens should be considered as „Potentially infectious‟.
„BIOHAZARD‟ stickers should be placed on all such specimen and request forms.
11.5 MANAGEMENT OF USED LENIN
Put all linen soiled with blood or body secretions, in isolation bag then in red plastic bag for laundry
return.
11.6 MANAGEMENT OF REUSABLE INSTRUMENT
All instruments soiled with blood or body fluids should be put first in isolation bag and then in red
plastic bag for central sterilized supply department (CSSD) return.
In small facilities where CSSD does not exist a clear decontamination and sterilization policy should
be developed in accordance with infection control principles and strictly adhered to.
12 PRESCRIBED AUTHORITY FOR MEDICAL WASTE MANAGEMENT
7
[(1) 8
[Save as otherwise provide, the prescribed authority for enforcement] of the provisions of these
rules shall be the State Pollution Control Boards in respect of States and the Pollution Control
Committees in respect of the Union Territories and all pending cases with a prescribed authority
appointed earlier shall stand transferred to the concerned State Pollution Control Board, or as the
case may be, the Pollution Control Committees].
7
Substituted by Rule 4 of the Bio-Medical Waste (M & H) (Second Amendment) Rules, 2000 vide notification S.O.545(E), dated 2.6.2000.
8
Substituted by Rule 2 (a) of the Bio-Medical Waste (M&H) (Amendment) Rules, 2003 vide notification S.O.1069 (E), dated 17.9.2003.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 37
9
[(1A)The prescribed authority for enforcement of the provisions of these rules in respect of all
health care establishments including hospitals, nursing homes, clinics, dispensaries, veterinary
institutions, Animal houses, pathological laboratories and blood banks of the Armed Forces under
the Ministry of Defence shall be the Director General, Armed Forces Medical Services].
(2) The prescribed authority for the State or Union Territory shall be appointed within one month
of the coming into force of these rules.
(3) The prescribed authority shall function under the supervision and control of the respective
Government of the State or Union Territory.
(4) The prescribed authority shall on receipt of Form I make such enquiry as it deems fit and if it
is satisfied that the applicant possesses the necessary capacity to handle bio-medical waste in
accordance with these rules, grant or renew an authorisation as the case may be.
(5) An authorisation shall be granted for a period of three years, including an initial trial period of
one year from the date of issue. Thereafter, an application shall be made by the occupier/operator for
renewal. All such subsequent authorisation shall be for a period of three years. A provisional
authorisation will be granted for the trial period, to enable the occupier/operator to demonstrate the
capacity of the facility.
(6) The prescribed authority may after giving reasonable opportunity of being heard to the applicant
and for reasons thereof to be recorded in writing, refuse to grant or renew authorisation.
(7) Every application for authorisation shall be disposed of by the prescribed authority within
ninety days from the date of receipt of the application.
(8) The prescribed authority may cancel or suspend an authorisation, if for reasons, to be recorded in
writing, the occupier/operator has failed to comply with any provision of the Act or these rules :
Provided that no authorisation shall be cancelled or suspended without giving a reasonable
opportunity to the occupier/operator of being heard.
9
Inserted sub-rule (1A) by Rule 2(b), ibid.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 38
13 AUTHORISATION AUTHORITIES OF MEDICAL WASTE
 Every occupier of an institution generating, collecting, receiving, storing, transporting,
treating, disposing and/or handling bio-medical waste in any other manner, except such
occupier of clinics, dispensaries, pathological laboratories, blood banks providing
treatment/service to less than 1000 (one thousand) patients per month, shall make an
application in Form I to the prescribed authority for grant of authorisation.
 Every operator of a bio-medical waste facility shall make an application in Form I to the
prescribed authority for grant of authorisation.
 Every application in Form I for grant of authorisation shall be accompanied by a fee as may
be prescribed by the Government of the State or Union Territory.
 10[(4)The authorisation to operate a facility shall be issued in Form IV, subject to conditions
laid therein and such other condition, as the prescribed authority, may consider it necessary.]
14 MAINTAINANCE OF RECORDS
 Every authorised person shall maintain records related to the generation, collection,
reception, storage, transportation, treatment, disposal and/or any form of handling of bio-
medical waste in accordance with these rules and any guidelines issued.
 All records shall be subject to inspection and verification by the prescribed authority at any
time.
15 GUIDELINES BY CPCB FOR MEDICAL WASTE TREATMENT PLANT
 A common bio-medical waste treatment facility (cbwtf) is a set up which has been legally
introduced in India.
 It is a set up where bio-medical waste, generated from a number of healthcare units, is
imparted necessary treatment to reduce adverse effects that this waste may pose.
 The treated waste may finally be sent for disposal in a landfill or for recycling purposes.
10
Inserted by Rule 5 of the Bio-Medical Waste (M&H) (Second Amendment) Rules, 2000 vide notification S.O.545(E), dated 2.6.2000.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 39
 Installation of individual treatment facilities by small healthcare units requires comparatively
high capital investment. In addition, it requires separate manpower and infrastructure
development for proper operation and maintenance of treatment systems.
 The concept of cbwtf not only addresses such problems but also prevents proliferation of
treatment equipment in a city. In turn it reduces the monitoring pressure on regulatory
agencies.
 Its considerable advantages have made cbwtf popular and proven concept in many developed
countries.
15.1 LOCATION OF A CBWTF
 A cbwtf shall be located far away from residential and sensitive area so that it has minimal
impact on these areas.
 Near to its area of operation as possible in order to minimize the travel distance in waste
collection, thus enhancing its operational flexibility.
 The location shall be decided in consultation with the state pollution control board
(spcb)/pollution control committee (pcc).
15.2 LAND REQUIREMENT
It is felt that a cbwtf will require minimum of 1 acre land area to provide all required systems.
15.3 COVERAGE AREA OF CBWTF
 In any area, only one cbwtf may be allowed to cater up to 10,000 beds.
 A cbwtf shall not be allowed to cater healthcare units situated beyond a radius of 150 km.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 40
16 CONCLUSION AND RECOMMENDATION
After doing this dissertation and going through all the studies I concluded that there are various laws,
standards, rules and regulations prescribed for medical waste management i.e. for segregation of
medical waste, handling of medical waste, holding of waste in a hospital compound, disposal of
waste and the treatment technologies for different type of medical wastes.
But there is still lack of compliance of medical waste management rules and regulations in the
practical field.
As the segregation of waste at the time of generation is not done properly or efficiently this leads to
the risk of infections to the patients as well as for the other people or staff in the hospital premises.
The litter bins for different types of wastes are sometimes placed to the close vicinity of the waiting
areas where there is always a high risk to the people of getting infected from dangerous diseases.
Lying of waste here and there without being concealed in the respective color coded bags can also be
seen in various health care facilities this is just due to the ignorance attitude of the staff members
involved in management of medical waste.
So, there is a special need of introducing various new technologies in management of medical waste
to reduce the human interventions and therefore reducing the risk for staff members and most
importantly to avoid the mistakes done by the or made by the human personnel in managing the
waste.
16.1 RECOMMENDATION
The recommendation includes the providing of small litter bins close to the place from where the
waste is generated but in the enclosed area to avoid the chances of spreading the infections in the
vicinity of hospitals.
The introduction of RFID (RADIO FREQUENCY IDENTIFICATION) in managing of medical
waste can also be done to manage the waste easily and efficiently.
RFID is a real time tracking tool that can automatically retrieve pre-stored data without human
intervention.
Radio frequency identification technology offers tracking capability to locate equipment and people
in real time.
It uses radio waves for data collection and transfer.
RFID tag is a small object, such as an adhesive sticker, that can be attached to or incorporated into a
product.
So, this is all that I want to recommend for the management of medical waste and making this
management more efficient so as to reduce the risks from medical waste.
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 41
Bibliography
(1998). THE BIO-MEDICAL WASTE (MANAGEMENT AND HANDLING) RULES,. New Delhi:
MINISTRY OF ENVIRONMENT & FORESTS.
Color Coding of wastes. (n.d.). Retrieved from www.envirovigil-
bmwm.com/Management/Segregation.html
CPCB. (n.d.). Bio-Medical Waste. parivesh.
Health Care Waste Management. (n.d.). Retrieved from https://www.gov.uk/healthcare-waste
Leybovich, F. (2012). Medical Waste Management.
WHO. (2011). Waste from health-care activities.
C Lee, George Huffman, and Richard Nalesnik Environmental Science & Technology 1991 25 (3), 360-
363
Links
http://en.wikipedia.org/wiki/Biomedical_waste
https://www.gov.uk/healthcare-waste
http://www.who.int/topics/medical_waste/en/
www.healthcarewaste.org/
MEDICAL WASTE MANAGEMENT
ISHIT BHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 42

Medical waste management report

  • 1.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 1 DISSERTATION On “Medical Waste Management” Submitted in partial fulfilment of the Requirement for the award of degree of Master of Architecture Submitted by Ishit Bharadwaj M-Arch- 1st sem Medical Architecture Guided by Abdul Halim Babbu FACULTY OF ARCHITECTURE & EKISTICS JAMIA MILLIA ISLAMIA NEW DELHI-110025 2013-2014
  • 2.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 2 Department of Architecture Faculty of Architecture & Ekistics, Jamia Millia Islamia, New Delhi Certificate In the partial fulfilment of the M-Arch degree program, this is to certify that „Ishit Bharadwaj‟ has worked on the Dissertation project entitled “Medical Waste Management” under my guidance and supervision. Abdul Halim Babbu Prof. S.M. Akhtar Guide Dean External Examiner 1 Abdul Halim Babbu Head of Department External Examiner 2
  • 3.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 3 Declaration I Ishit Bharadwaj hereby declare that the Dissertation entitled “Medical Waste Management” submitted in the partial fulfilment of the requirements for the award of the degree of Masters of Architecture is my original design/ research work and that the information taken from secondary sources is given due citations and references. [Signature] Ishit Bharadwaj Roll. No: Date: M.Arch. Sem. - 1st Place: 2013-14
  • 4.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 4 Acknowledgment At various stages in doing of thesis, a number of people have given me invaluable support.In this regard I owe a depth of gratitude to my inspiration & guide Abdul Halim Babbu. Who have cultivated devotion & determination in me & have been a helping hand at every moment to support & motivate me. I would deeply thank To the Classmates for the systematic structuring the dissertation so as to make it an gradual process of learning and application; for his regular evoking insightful discussions. I am Grateful to My Parents, who kept ultimate faith in me & always provided me backup with their love & best wishes. Above all, I am highly grateful to God, who provided me such a golden opportunity, brilliant guidance, & kind support. I would finally thank My Friends for the much needed pep talks and discussions and all those who made this thesis come alive. At last I beg pardon from all those who helped me but, my self-centered mind escaped their names With Regards, Ishit Bharadwaj M-Arch – Ist sem Medical Architecture
  • 5.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 5 Abstract Bio medical waste (BMW) collection and proper disposal has become a significant concern for both the medical and general community. Effective management of biomedical waste is not only a legal necessity but also a social responsibility. A review of medical waste management systems was performed to understand (a) the various handling and disposal procedures (b) the knowledge and awareness of individuals involved in medical waste generation, handling and disposal, and (c) the potential impacts of the waste stream on both human health and the natural environment. The purpose of the study is to provide direction for further study. Information was collected mainly from literature review and online search. It was found that a variety of methods were used by the medical facilities to dispose their wastes including burning, burial, entombing, selling, dumping, and removal by municipal bins. The waste disposal practice was found to be quite unsafe, and both clinical and non-clinical wastes were found to be thrown together. There was insufficient awareness of the magnitude of the medical wastes issue by concerned individuals At different levels, study showed that the hospital staff including high officials, and waste “haulers” was not aware of the safe disposal and handling of hospital waste. Laboratory analysis showed severe contamination of infectious wastes to the environment. Children, adults, and animals all have the potential to come into contact with these wastes which may pose severe health risks to them. There was no safety measure observed in dealing with waste disposal or laboratory analysis of infectious or hazardous diseases. The chemicals used for the staining and preservation of slides and for the sterilization and cleaning of equipment and surroundings are potentially harmful to the laboratory technician and the environment. Hospital wastes pose a significant impact on health and environment. From this study it can be said that there is an urgent need for raising awareness and education on medical waste issues. Proper waste management strategy is needed to ensure health and environmental safety. For further study, it is needed to collect more information on impacts, disposal and management to draw a clear conclusion. Need to collect information and examples from developed country or the country, which has sound medical waste management system. Find alternatives and appropriate technologies for developing countries. Need extensive study on this medical waste and its management aspects as well.
  • 6.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 6 Table of Contents 1 SUMMARY..................................................................................................................................................10 1.1 INTRODUCTION..................................................................................................................................10 1.2 NEED OF THE STUDY ..........................................................................................................................10 1.3 AIMS AND OBJECTIVES.......................................................................................................................10 1.4 LIMITATIONS OF THE STUDY..............................................................................................................11 1.5 METHODOLOGY .................................................................................................................................11 2 INTRODUCTION..........................................................................................................................................12 2.1 MEDICAL WASTE................................................................................................................................12 2.2 NEED OF MEDICAL WASTE MANAGEMENT.......................................................................................12 2.3 FACTS AND FIGURES OF MEDICAL WASTE.........................................................................................13 3 TYPES AND SOURCES OF MEDICAL WASTE (HAZARDOUS WASTE) ...........................................................14 3.1 PERCENTAGE DISTRIBUTION OF HAZARDOUS WASTE ......................................................................14 3.2 DESCRIPTION OF DIFFERENT MEDICAL WASTE .................................................................................15 3.3 MAJOR SOURCES OF MEDICAL WASTE..............................................................................................15 4 INJURIES BY MEDICAL WASTE AND SOME EXAMPLES...............................................................................16 4.1 INJURIES OCCURRED IN PAST.............................................................................................................16 4.1.1 DUE TO SHARPS..........................................................................................................................16 4.1.2 DUE TO VACCINE WASTE ...........................................................................................................16 4.1.3 DUE TO RADIOACTIVE WASTE....................................................................................................16 5 PRINCIPLES OF WASTE MANAGEMENT .....................................................................................................17 5.1 SORTING.............................................................................................................................................17 5.2 HANDLING..........................................................................................................................................17 5.3 INTERIM .............................................................................................................................................17 5.4 DISPOSAL............................................................................................................................................17 6 SEGREGATION OF MEDICAL WASTE ..........................................................................................................18 6.1 NECESSITY OF SEGREGATING MEDICAL WASTE ................................................................................18 6.2 COLOR CODING OF WASTE ................................................................................................................18 6.2.1 HOW IT HELPS............................................................................................................................18 6.2.2 DEMARKATION OF COLORS .......................................................................................................18 6.3 CATEGORIES OF WASTE .....................................................................................................................20
  • 7.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 7 Human Anatomical Waste .................................................................................................................................20 Animal Waste.....................................................................................................................................................20 Waste sharps......................................................................................................................................................20 [Soiled] Waste....................................................................................................................................................21 Solid Waste ........................................................................................................................................................21 Liquid Waste ......................................................................................................................................................21 Incineration Ash.................................................................................................................................................21 Chemical Waste .................................................................................................................................................22 6.4 COLOR CODING, TYPE OF CONTAINER AND TREATMENT OPTIONS..................................................22 7 HANDLING AND TRANSPORT OF MEDICAL WASTE ...................................................................................23 7.1 ON SITE TRANSPORT..........................................................................................................................23 7.2 OFF SITE TRANSPORT.........................................................................................................................23 7.3 BAG FILLIING ......................................................................................................................................23 8 INTERIM STORAGE .....................................................................................................................................24 8.1 RECOMMENDATIONS FOR HOLDING WASTE IN HEALTH CARE FACILITIES.......................................25 9 SEGREGATION, PACKAGING, TRANSPORTATION AND STORAGE (A BRIEF IN ALL)...................................26 10 TREATMENT AND DISPOSAL ..................................................................................................................27 10.1 TREATMENT TECHNOLOGIIES............................................................................................................27 10.2 INCINERATION....................................................................................................................................28 10.2.1 STANDARDS FOR INCINERATORS...............................................................................................28 10.3 AUTOCLAVING....................................................................................................................................30 10.3.1 STANDARDS FOR WASTE AUTOCLAVING...................................................................................31 10.4 MICROWAVING..................................................................................................................................32 10.4.1 STANDARDS FOR MICROWAVING..............................................................................................32 10.5 HYDROCLAVING .................................................................................................................................33 10.6 IRRADIATION......................................................................................................................................33 10.7 CHEMICAL DISINFECTING...................................................................................................................33 10.7.1 STANDARDS FOR LIQUID WASTE ...............................................................................................34 10.8 SHREDDING........................................................................................................................................34 10.8.1 STANDARDS FOR DEEP BURIAL..................................................................................................34 11 SAFETY MEASURES WHILE HANDLING MEDICAL WASTE ......................................................................35 11.1 HAZARDOUS CHEMICAL WASTE ........................................................................................................35 11.2 DISPOSAL OF USED SYRINGES............................................................................................................35 11.3 SAFE SHARPS DISPOSAL .....................................................................................................................35 11.3.1 SHARPS CONTAINER DISPOSAL CRITERIA ..................................................................................35
  • 8.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 8 11.4 DISPOSAL OF LABORATORIES SPECIMENS.........................................................................................36 11.5 MANAGEMENT OF USED LENIN.........................................................................................................36 11.6 MANAGEMENT OF REUSABLE INSTRUMENT.....................................................................................36 12 PRESCRIBED AUTHORITY FOR MEDICAL WASTE MANAGEMENT..........................................................36 13 AUTHORISATION AUTHORITIES OF MEDICAL WASTE............................................................................38 14 MAINTAINANCE OF RECORDS................................................................................................................38 15 GUIDELINES BY CPCB FOR MEDICAL WASTE TREATMENT PLANT .........................................................38 15.1 LOCATION OF A CBWTF .....................................................................................................................39 15.2 LAND REQUIREMENT .........................................................................................................................39 15.3 COVERAGE AREA OF CBWTF..............................................................................................................39 16 CONCLUSION AND RECOMMENDATION ...............................................................................................40 16.1 RECOMMENDATION ..........................................................................................................................40
  • 9.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 9 List of Figures Figure 7. 1 Trolley used for transport of waste....................................................................................23 Figure 7. 2 Sign of bio hazard waste at bags .......................................................................................23 Figure 8. 1 Containers for storage of waste .........................................................................................24 Figure 8. 2 Container for infectious waste...........................................................................................25 Figure 10. 1 Incinerator machine used for treating waste....................................................................28 Figure 10. 2 Process for incineration ...................................................................................................28 Figure 10. 3 Autoclave machine ..........................................................................................................30 Figure 10. 4 An autoclaving unit .........................................................................................................30
  • 10.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 10 1 SUMMARY 1.1 INTRODUCTION Medical waste or clinical waste refers to the waste that is generated by health care premises such as hospitals , clinics , doctor‟s offices , veterinary hospitals and labs and is cannot be considered as general waste. 1.2 NEED OF THE STUDY Poor management of health care waste potentially exposes health care workers, waste handlers, patients and the community at large to infection, toxic effects and injuries, and risks polluting the environment. So, it is essential that all medical waste materials are segregated at the point of generation, appropriately treated and disposed of safely. 1.3 AIMS AND OBJECTIVES  The basic aim is to protect the public and the environment from potentially infectious diseases caused due to lack of management of medical waste.  To find out the types of wastes produced by the hospital and how much it is affecting the living animals i.e. humans or animals.  To find out the linkages between the clean area and dirty area in the hospital.  To find out how the waste is segregated at its generation point, how it is treated inside a hospital compound and how it is disposed.  To find out the awareness of waste management amongst the hospital staff.  The objective of this study is to safeguard the lives of humans, animals or plants from any disease.  To cut down the risk of cutting and edging of waste handlers.  To prevent the use of used products such as syringes which is a major cause to communicate any disease.
  • 11.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 11 1.4 LIMITATIONS OF THE STUDY  This study will not deal with the technical issues regarding the treatment of medical waste.  The diseases caused due to the poor waste management will be briefly discussed not will be fully elaborated. 1.5 METHODOLOGY  The study will be based on the information provided on the internet and architecture journals or magazines.  Information from case study of different hospitals will also be mentioned.  Interaction with the related people will also be done to do a better research.  Interaction with the hospital staff will also be done to know the awareness of waste management among them.  To frame out certain guidelines which would help in management of medical waste in a better way and to preserve the environment and lives from its adverse effects.
  • 12.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 12 2 INTRODUCTION 2.1 MEDICAL WASTE Medical waste means any solid and/or liquid waste including its container and any intermediate product, which is generated during the diagnosis, treatment or immunization of human beings or animals or in research or in the production or testing. OR Any waste which consists entirely or partly of human or animal tissue, blood or other body fluids, excretions, drugs or other pharmaceutical products, dressings or syringes, needles or other sharp instruments. Medical waste includes all infectious waste, hazardous (including low-level radioactive wastes), and any other wastes that are generated from all types of health care institutions, including hospitals, clinics, doctor‟s (including dental and veterinary) offices and medical laboratories. 2.2 NEED OF MEDICAL WASTE MANAGEMENT Poor management of health care waste potentially exposes health care workers, waste handlers, patients and the community at large to infection, toxic effects and injuries, and risks polluting the environment. Health-care waste contains harmful micro- organisms which can infect hospital patients, health-care workers and the general public Other potential infectious risks may include the spread of drug-resistant micro-organisms from health-care establishments into the environment. Figure2. 1 Medical waste of several types Figure2. 2 Inappropriate disposal of waste
  • 13.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 13 Medical waste can potentially be re used without sterilization, this reuse of non-sterile waste material poses a serious threat of the diseases. It may also damage the environment (e.g. ,contamination of water, air, and food).in addition, if waste is not disposed off properly, members of the community may have an opportunity to collect disposable medical items (particularly syringes) and to re pack and sell these materials.. 2.3 FACTS AND FIGURES OF MEDICAL WASTE  Of the total medical waste 80% is the general waste which can be comparable to domestic waste.  The remaining 20% is considered hazardous which may be infectious, toxic or radioactive.  High-income countries generate on average up to 0.5 kg of hazardous waste per bed per day.  While low-income countries generate on average 0.2 kg of hazardous waste per bed per day.  However, health-care waste is often not separated into hazardous or non-hazardous wastes in low-income countries making the real quantity of hazardous waste much higher. Figure2.3 Rag picker collecting useful materials from waste
  • 14.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 14 3 TYPES AND SOURCES OF MEDICAL WASTE (HAZARDOUS WASTE) 3.1 PERCENTAGE DISTRIBUTION OF HAZARDOUS WASTE INFECTIOUS WASTE PATHOLOGICA L WASTE SHARPS CHEMICAL WASTE PHARMACEUTICAL WASTE GENOTOXIC WASTE HEAVY METAL WASTE
  • 15.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 15 3.2 DESCRIPTION OF DIFFERENT MEDICAL WASTE Infectious waste: waste contaminated with blood and its by-products, cultures and stocks of infectious agents, waste from patients in isolation wards, discarded diagnostic samples containing blood and body fluids, infected animals from laboratories, and contaminated materials (swabs, bandages) and equipment (such as disposable medical devices). Pathological waste: recognizable body parts and contaminated animal car cases. Sharps: syringes, needles, disposable scalpels and blades, etc. Chemical waste: for example mercury, solvents and disinfectants. Pharmaceuticals: expired, unused, and contaminated drugs; vaccines and sera. Genotoxic waste: highly hazardous, mutagenic, teratogenic1 or carcinogenic, such as cytotoxic drugs used in cancer treatment and their metabolites. Radioactive waste: such as glassware contaminated with radioactive diagnostic material or radio therapeutic materials. Heavy metals waste: such as broken mercury thermometers. 3.3 MAJOR SOURCES OF MEDICAL WASTE  Hospitals and other health-care establishments.  Laboratories and research centres.  Mortuary and autopsy centres.  Animal research and testing laboratories  Blood banks and collection services  Nursing homes for the elderly.
  • 16.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 16 4 INJURIES BY MEDICAL WASTE AND SOME EXAMPLES  Radiation burns;  Sharps-inflicted injuries;  Poisoning and pollution through the release of pharmaceutical products, in particular, antibiotics and cytotoxic drugs;  Poisoning and pollution through waste water;  Poisoning and pollution by toxic elements or compounds, such as mercury or dioxins that are released during incineration. 4.1 INJURIES OCCURRED IN PAST 4.1.1 DUE TO SHARPS Who estimated that, in 2000, injections with contaminated syringes caused 21 million hepatitis b virus (hbv) infections, two million hepatitis c virus infections and 260 000 hiv infections worldwide. Many of these infections were avoidable if the syringes had been disposed of safely. 4.1.2 DUE TO VACCINE WASTE In june 2000 six children were diagnosed with a mild form of smallpox (vaccinia virus) after having played with glass ampoules containing expired smallpox vaccine at a garbage dump in vladivostok (russia). 4.1.3 DUE TO RADIOACTIVE WASTE Serious accidents have been documented in brazil in 1988 (where four people died and 28 had serious radiation burns), mexico and morocco in 1983, algeria in 1978 and mexico in 1962. Figure 4.1 Burial of medical waste in open environment
  • 17.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 17 5 PRINCIPLES OF WASTE MANAGEMENT FOUR MAIN PRINCIPLES ARE 5.1 SORTING Sorting is separating waste by type (e.g., infectious waste, pharmaceutical waste) into color-coded bags at the place where it is generated. 5.2 HANDLING Handling is collecting and transporting waste within the facility. 5.3 INTERIM Interim storage is storing waste within the facility until it can be transported for final disposal. 5.4 DISPOSAL Final disposal is the elimination of solid medical waste, liquid medical waste, sharps, and hazardous chemical waste from the health facility. SORTING HANDLING INTERIM STORAGE DISPOSAL
  • 18.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 18 6 SEGREGATION OF MEDICAL WASTE 6.1 NECESSITY OF SEGREGATING MEDICAL WASTE  The plastic that is used in the hospitals is infected. It gets mixed with the other waste which lies exposed till it is collected by the municipality.  The rag pickers come and collect it. In the process they handle this with bare hands, which is a hazardous practice.  They sell this plastic material. This material is repackaged and sold. It is injurious to health.  It is necessary to recycle this plastic. It should first be disinfected. Hence it must be segregated from non infectious waste.  To make the process easier color coded bags are provided by the organization. 6.2 COLOR CODING OF WASTE 6.2.1 HOW IT HELPS  Tells other staff what is in the container.  Tells the contractor what to do with the waste.  Can apply to both sacks and rigid containers. 6.2.2 DEMARKATION OF COLORS  This bag is used for collecting dry waste material which is not infectious.  Materials like paper, plastics, cardboard boxes, and other dry waste generated in hospital office or in the wards are disposed in this bag.  This is not biomedical waste.  This bag is used for highly infectious items  Like pathological waste, human anatomical waste such as body parts, amputated parts/organs, tumors, placentas, aborted or dead fetuses, blood soaked cotton bandages, animal tissues, organs, carcasses etc. Figure 6. 1Black bag or bin Figure 6. 2 Yellow bag or bin
  • 19.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 19  This bag is used for collecting the segregated metal sharps such as needles, blades, saws, scalpels and glass pieces.  These bags must be puncture proof.  A metal box or a plastic canister should be used for collecting the metal sharps.  It is strongly recommended that even metal sharps and broken glass articles should be segregated.  Broken glass sharps should be collected in blue/ white bags.  This bag is used for the disposal of plastics collected from Ot‟s, icu‟s and wards.  These containers are used for collecting radioactive wastes.  This waste is to be disposed as per the guidelines provided by bhabha atomic research centre (barc), mumbai.  Radioactive wastes, especially cobalt needles used for brachy treatment must be returned to barc.  Cytotoxic waste can be stored in sturdy cardboard boxes and later can be incinerated. Figure 6. 3 White and Blue bin Figure 6. 4 Red bag Figure 6. 5 Lead container for radioactive waste
  • 20.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 20 6.3 CATEGORIES OF WASTE 1 [Waste Category No.] Waste Category 2 [Type] Treatment and Disposal 3 [Option +] Category No.1 Human Anatomical Waste (human tissues, organs, body parts ) Incineration@ /deep burial* Category No.2 Animal Waste (animal tissues, organs, body parts carcasses, bleeding parts, fluid, blood and experimental animals used in research, waste generated by veterinary hospitals, colleges, discharge from hospitals, animal houses) Incineration@ /deep burial* Category No.3 Microbiology & Biotechnology Wastes (Wastes from laboratory cultures, stocks or specimens of micro- organisms live or attenuated vaccines, human and animal cell culture used in research and infectious agents from research and industrial laboratories, wastes from production of biologicals, toxins, dishses and devices used for transfer of cultures) local autoclaving/micro- waving/incineration@ Category No.4 Waste sharps (needles, syringes, scalpels, blades, glass etc. that may cause puncture and cuts. This includes disinfection (chemical treatment@@ /auto claving/ microwaving and multilation /shredding ## 1 Substituted by Rule 9 (i) of the Bio-Medical Waste (M & H) (Second Amendment) Rules, 2000 notified vide S.O.545(E), dated 2.6.2000. 2 Added by Rule 9(ii), ibid. 3 Substituted by Rule 9 (iii), ibid.
  • 21.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 21 both used and unused sharps) Category No.5 Discarded Medicines and Cytotoxic drugs (wastes comprising of outdated, contaminated and discarded medicines) incineration@ /destruction and drugs disposal in secured landfills Category No.6 4 [Soiled] Waste (Items contaminated with blood, and body fluids including cotton, dressings, soiled plaster casts, lines beddings, other material contaminated with blood) incineration @ autoclaving/microwaving Category No.7 Solid Waste (wastes generated from disposable items other than the waste 5 [sharps] such as tubings, catheters, intravenous sets etc.) disinfection by chemical treatment@@ autoclaving/ microwaving and mutilation/shredding## Category No.8 Liquid Waste (waste generated from laboratory and washing, cleaning, house- keeping and disinfecting activities) disinfection by chemical treatment @@ and discharge into drains. Category No.9 Incineration Ash (ash from incineration of any bio-medical waste) disposal in municipal landfill 4 Substituted by rule 9(iv), ibid. 5 Substituted by Rule 9 (v) of the Bio-Medical Waste (M & H) (Second Amendment) Rules, 2000 notified vide S.O.545(E), dated 2.6.2000.
  • 22.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 22 Category No.10 Chemical Waste (chemicals used in production of biologicals, chemicals used in disinfection, as insecticides etc.) Chemical treatment @@ and discharge into drains for liquids and secured landfill for solids 6.4 COLOR CODING, TYPE OF CONTAINER AND TREATMENT OPTIONS Colour Coding Type of Container Waste Category Treatment options as per Schedule I Yellow Plastic bag Cat.1, Cat. 2, Cat.3, Cat. 6 Incineration/deep burial Red Disinfected container/plastic bag Cat. 3, Cat.6, Cat.7 Autoclaving/Microwaving/ Chemical Treatment Blue/White translucent Plastic bag/puncture proof container Cat.4, Cat.7 Autoclaving/Microwaving/ Chemcial Treatment and destruction/shredding Black Plastic bag Cat.5 and Cat.9 and Cat.10 (Solid) Disposal in secured landfill Notes: 1. Colour coding of waste categories with multiple treatment options as defined in Schedule I, shall be selected depending on treatment option chosen, which shall be as specified in Schedule I. 2. Waste collection bags for waste types needing incineration shall not be made of chlorinated plastics. 3. Categories 8 and 10 (liquid) do not require containers/bags. 4. Category 3 if disinfected locally need not be put in containers/bags.
  • 23.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 23 7 HANDLING AND TRANSPORT OF MEDICAL WASTE  Medical waste should be handled as little as possible before disposal.  It should not be collected from patient-care areas by emptying into open carts; this may lead to contamination of the surroundings and to scavenging of waste as well as to an increased risk of injury to staff, clients and visitors. 7.1 ON SITE TRANSPORT Health-care waste should be transported within the hospital or other facility by means of wheeled trolleys, containers, or carts that are not used for any other purpose and meet the following specifications:  Easy to load and unload;  No sharp edges that could damage waste bags or containers during loading and unloading;  Easy to clean The vehicles should be cleaned and disinfected daily with an appropriate disinfectant. Different colored bags have to be segregated in the storage room. 7.2 OFF SITE TRANSPORT  Waste should be arranged by concerned municipal / local authority.  The waste should be transferred to the vehicle by sanitary worker under the supervision of WMO. 7.3 BAG FILLIING  Waste and sharps containers should be discarded when they become three quarters full and at least once daily or after each shift.  The reason for this is to reduce the risk of plastic bags splitting open and of an injury from a protruding sharp item in sharps containers. Figure 7. 1 Trolley used for transport of waste Figure 7. 2 Sign of bio hazard waste at bags
  • 24.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 24 8 INTERIM STORAGE  Waste should be transported to interim storage at the end of every shift. To reduce the risk of infection and of injury, minimize the amount of time waste is stored at the facility.  Waste should be stored in an area of controlled access that is minimally trafficked by staff, clients, and visitors.  Interim storage time should not exceed two days.  It is preferable to have a room to store waste on each floor of the facility, but, if this is difficult, one central storage room should be designated.  The storage area should also be included in a cleaning schedule.  A storage location for health-care waste should be designated inside the health-care establishment or research facility.  The waste, in bags or containers, should be stored in a separate area, room, or building of a size appropriate to the quantities of waste produced and the frequency of collection. Source - www.emag.suez-environnement.com Unless a refrigerated storage room is available, storage times for healthcare waste (i.e. The delay between production and treatment) should not exceed the following: Temperate climate: 72 hours in winter 48 hours in summer Warm climate: 48 hours during the cool season 24 hours during the hot season Figure 8. 1 Containers for storage of waste
  • 25.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 25 Cytotoxic waste  Should be stored separately from other health-care waste in a designated secure location. Radioactive waste  Should be stored in containers that prevent dispersion, behind lead shielding.  Waste that is to be stored during radioactive decay should be labelled with the type of radionuclide, the date, and details of required storage conditions. 8.1 RECOMMENDATIONS FOR HOLDING WASTE IN HEALTH CARE FACILITIES  The storage area should have an impermeable, hard-standing floor with good drainage; it should be easy to clean and disinfect.  There should be a water supply for cleaning purposes.  The storage area should afford easy access for staff in charge of handling the waste.  It should be possible to lock the store to prevent access by unauthorized persons.  Easy access for waste-collection vehicles is essential.  There should be protection from the sun.  The storage area should be inaccessible for animals, insects, and birds.  There should be good lighting and at least passive ventilation.  The storage area should not be situated in the proximity of fresh food stores or food preparation areas.  A supply of cleaning equipment, protective clothing, and waste bags or containers should be located conveniently close to the storage area. Figure 8. 2 Container for infectious waste Source - www.emag.suez-environnement.com
  • 26.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 26 9 SEGREGATION, PACKAGING, TRANSPORTATION AND STORAGE (A BRIEF IN ALL)  Bio-medical waste shall not be mixed with other wastes.  Bio-medical waste shall be segregated into containers/bags at the point of generation in accordance with Schedule II prior to its storage, transportation, treatment and disposal. The containers shall be labeled according to Schedule III.  If a container is transported from the premises where bio-medical waste is generated to any waste treatment facility outside the premises, the container shall, apart from the label prescribed in Schedule III, also carry information prescribed in Schedule IV.  Notwithstanding anything contained in the Motor Vehicles Act, 1988, or rules thereunder, untreated bio-medical waste shall be transported only in such vehicle as may be authorised for the purpose by the competent authority as specified by the Government.  No untreated bio-medical waste shall be kept stored beyond a period of 48 hours : provided that if for any reason it becomes necessary to store the waste beyond such period, the authorised person must take permission of the prescribed authority and take measures to ensure that the waste does not adversely affect human health and the environment.  6[(6)The Municipal body of the area shall continue to pick up and transport segregated non bio-medical solid waste generated in hospitals and nursing homes, as well as duly treated bio- medical wastes for disposal at municipal dump site]. 6 Inserted by Rule 3 of the Bio-Medical Waste (M & H) (Second Amendment) Rules, 2000 vide notification S.O.545(E), dated 2.6.2000.
  • 27.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 27 10 TREATMENT AND DISPOSAL  Bio-medical waste shall be treated and disposed of in accordance with Schedule I, and in compliance with the standards prescribed in Schedule V.  Every occupier, where required, shall set up in accordance with the time-schedule in Schedule VI, requisite bio-medical waste treatment facilities like incinerator, autoclave, microwave system for the treatment of waste, or, ensure requisite treatment of waste at a common waste treatment facility or any other waste treatment facility. 10.1 TREATMENT TECHNOLOGIIES  These are the technologies used for treatment of medical waste.  These treatments are done for different types of medical waste as per the category they lie under.  Treatment can be done inside the hospital compound at a small level and at a common treatment facility also provided by the government. TREATMENT TECHNOLOGIES OF MEDICAL WASTE
  • 28.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 28 10.2 INCINERATION  Incineration is a waste treatment process that involves the combustion of organic substances contained in waste materials. Incineration and other high- temperature waste treatment systems are described as “thermal treatment".  Incineration of waste materials converts the waste into ash,fumes,gas and heat.  It is a controlled combustion process where waste is completely  Oxidized and harmful microorganisms present in it are destroyed/  Denatured under high temperature.  According to the EPA 90% of medical waste is incinerated.  Strict regulations regarding air emissions.  Incinerator ash is generally land filled. 10.2.1 STANDARDS FOR INCINERATORS All incinerators shall meet the following operating and emission standards : A. Operating Standards 1. Combustion efficiency (CE) shall be at least 99.00%. Figure 10. 1 Incinerator machine used for treating waste Figure 10. 2 Process for incineration
  • 29.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 29 2. The Combustion efficiency is computed as follows : %CO2 C.E. =____________________ x 100 % CO2+ % CO The temperature of the primary chamber shall be 800 ± 50co . The secondary chamber gas residence time shall be at least 1 (one) second at 1050 ± 50co , with minimum 3% Oxygen in the stack gas. B. Emission Standards Parameters Concentration mg/Nm3 at (12% CO2 correction) (1) Particulate matter 150 (2) Nitrogen Oxides 450 (3) HCl 50 (4) Minimum stack height shall be 30 metres above ground. (5) Volatile organic compounds in ash shall not be more than 0.01%. Note : Suitably designed pollution control devices should be installed/retrofitted with the incinerator to achieve the above emission limits, if necessary. Wastes to be incinerated shall not be chemically treated with any chlorinated disinfectants. Chlorinated plastics shall not be incinerated. Toxic metals in incineration ash shall be limited within the regulatory quantities as defined under the Hazardous Waste (Management and Handling ) Rules, 1989. Only low sulphur fuel like L.D.O./L.S.H.S./Diesel shall be used as fuel in the incinerator.
  • 30.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 30 10.3 AUTOCLAVING Highly effective and inexpensive,unsuitable for heat sensitive objects. DESIGN AND CONTROL: To be effective against spore forming bacteria and viruses, autoclaves need to: Have steam in direct contact with the material being sterilized (i.e. loading of items is very important). Create vacuum in order to displace all the air initially present in the autoclave and replacing it with steam. Implement a well designed control scheme for steam evacuation and cooling so that the load does not perish. The efficiency of the sterilization process depends on two major factors:  One of them is the thermal death time, i.e. the time microbes must be exposed to at a particular temperature before they are all dead.  The second factor is the thermal death point or temperature at which all microbes in a sample are killed. The steam and pressure ensure sufficient heat is transferred into the organism to kill them. A series of negative pressure pulses are used to vacuum all possible air pockets, while steam penetration is maximized by application of a succession of positive pulses Figure 10. 4 An autoclaving unit Figure 10. 3 Autoclave machine
  • 31.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 31  Autoclaving is a low-heat thermal process where steam is brought into direct contact with waste in a controlled manner and for sufficient duration to disinfect the wastes.  For ease and safety in operation, the system should be horizontal type and exclusively designed for the treatment of bio-medical waste.  Often followed by compaction process, and eventually reaches landfills. 10.3.1 STANDARDS FOR WASTE AUTOCLAVING The autoclave should be dedicated for the purposes of disinfecting and treating bio-medical waste, (I) When operating a gravity flow autoclave, medical waste shall be subjected to : (i) a temperature of not less than 121o C and pressure of 15 pounds per square inch (psi) for an autoclave residence time of not less than 60 minutes; or (ii) a temperature of not less than 135o C and a pressure of 31 psi for an autoclave residence time of not less than 45 minutes; or (iii) a temperature of not less than 149o C and a pressure of 52 psi for an autoclave residence time of not less than 30 minutes. (II) When operating a vacuum autoclave, medical waste shall be subjected to a minimum of one pre-vacuum pulse to purge the autoclave of all air. The waste shall be subjected to the following : a temperature of not less than 121o C and pressure of 15 psi per an autoclave residence time of not less than 45 minutes ; or (ii) a temperature of not less than 135o C and a pressure of 31 psi for an autoclave residence time of not less than 30 minutes; (III) Medical waste shall not be considered properly treated unless the time, temperature and pressure indicators indicate that the required time, temperature and pressure were reached during the autoclave process. If for any reasons, time temperature or pressure indicator indicates that the required temperature, pressure or residence time was not reached , the entire load of medical waste must be autoclaved again until the proper temperature, pressure and residence time were achieved. (IV) Recording of operational parameters Each autoclave shall have graphic or computer recording devices which will automatically and continuously monitor and record dates, time of day, load identification number and operating parameters throughout the entire length of the autoclave cycle.
  • 32.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 32 (V) Validation test Spore testing : The autoclave should completely and consistently kill approved biological indicator at the maximum design capacity of each autoclave unit. Biological indicator for autoclave shall be Bacillus stearothermophilus spores using vials or spore strips, with at least 1x104 spores per millilitre. Under no circumstances will an autoclave have minimum operating parameters less than a residence time of 30 minutes, regardless of temperature and pressure, a temperature less than 121o C or a pressure less than 15 psi. (VI) Routine Test A chemical indicator strip/tape that changes colour when a certain temperature is reached can be used to verify that a specific temperature has been achieved. It may be necessary to use more than one strip one strip over the waste package at different location to ensure that the inner content of the package has been adequately autoclaved. 10.4 MICROWAVING  In microwaving, microbial inactivation occurs as a result of the thermal effect of electromagnetic radiation spectrum lying between the frequencies 300 and 300,000 mhz.  The heating occurs inside the waste material in the presence of steam. 10.4.1 STANDARDS FOR MICROWAVING 1. Microwave treatment shall not be used for cytotoxic, hazardous or radioactive wastes, contaminated animal carcasses, body parts and large metal items. 2. The microwave system shall comply with the efficacy test/routine tests and a performance guarantee may be provided by the supplier before operation of the unit. 3. The microwave should completely and consistently kill the bacteria and other pathogenic organisms that is ensured by approved bio-logical indicator at the maximum design capacity of each microwave unit. Biological indicators for microwave shall be Bacillus Subtilis spores using vials or spore strips with at least 1x104 spores per milliliter.
  • 33.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 33 10.5 HYDROCLAVING Hydroclaving is similar to that of autoclaving except that the waste is subjected to indirect heating by applying steam in the outer jacket. The waste is continuously tumbled in the chamber during the process. 10.6 IRRADIATION  Exposure of waste to cobalt source gamma radiation inactivates all microbes.  Special treatment sites are required (no mobile or in house process)  High capital cost.  Operators‟ safety risk in irradiation plant is an issue.  Does not sterilize pathological wastes. 10.7 CHEMICAL DISINFECTING  Primarily through the use of chlorine products.  Waste is first shredded and mixed with water.  Though chemical disinfection is also an option for the treatment of certain categories of bio-medical waste but looking at the volume of waste to be
  • 34.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 34 disinfected at the cbwtf and the pollution load associated with the use of disinfectants,  The use of chemical disinfection for the treatment of bio-medical waste at cbwtf is not recommended. 10.7.1 STANDARDS FOR LIQUID WASTE The effluent generated from the hospital should conform to the following limits : PARAMETERS PERMISSIBLE LIMITS pH 6.5-9.0 Suspended solids 100 mg/1 Oil and grease 10 mg/1 BOD 30 mg/1 COD 250 mg/1 Bio-assay test 90% survival of fish after 96 hours in 100% effluent These limits are applicable to those hospitals which are either connected with sewers without terminal sewage treatment plant or not connected to public sewers. For discharge into public sewers with terminal facilities, the general standards as notified under the Environment (Protection) Act, 1986 shall be applicable. 10.8 SHREDDING Shredding is a process by which waste are deshaped or cut into smaller pieces so as to make the wastes unrecognizable. It helps in prevention of reuse of bio-medical waste and also acts as identifier that the waste have been disinfected and are safe to dispose off. 10.8.1 STANDARDS FOR DEEP BURIAL  A pit or trench should be dug about 2 metres deep. It should be half filled with waste, then covered with lime within 50 cm of the surface, before filling the rest of the pit with soil.  It must be ensured that animals do not have any access to burial sites. Covers of galvanized iron/wire meshes may be used.  On each occasion, when wastes are added to the pit, a layer of 10 cm of soil shall be added to cover the wastes.  Burial must be performed under close and dedicated supervision.  The deep burial site should be relatively impermeable and no shallow well should be close to the site.
  • 35.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 35  The pits should be distant from habitation, and sited so as to ensure that no contamination occurs of any surface water or groundwater. The area should not be prone to flooding or erosion.  The location of the deep burial site will be authorized by the prescribed authority.  The institution shall maintain a record of all pits for deep burial. 11 SAFETY MEASURES WHILE HANDLING MEDICAL WASTE 11.1 HAZARDOUS CHEMICAL WASTE  Always wear heavy utility gloves and shoes when handling or transporting hazardous chemical waste.  Afterwards, wash both gloves and shoes if they become contaminated.  Cleaning solutions and disinfectants should be handled as liquid medical waste.  After disposal, rinse containers thoroughly with water, wash glass containers with detergent and water.  Do not reuse plastic containers.  Disposing of cytotoxic and radioactive waste should be done in accordance with all local and national laws and regulations. 11.2 DISPOSAL OF USED SYRINGES Place all used syringes in designated sharps container and never recap needles. 11.3 SAFE SHARPS DISPOSAL Never discard needles and sharps in clinical waste bags, as the housekeeping staff might get injured. 11.3.1 SHARPS CONTAINER DISPOSAL CRITERIA There are four major criteria for sharps disposal container safety performance: Functionality, Accessibility, Visibility & Accommodation: Functionality: Containers should remain in a good state during their entire usage. They should be leak resistant on their sides and bottoms and puncture resistant until final disposal. Individual
  • 36.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 36 containers should have adequate volume and safe access to the opening. Accessibility: Containers should be accessible to all workers who use, maintain, or dispose off sharp devices. Containers should be placed in all areas where sharps are used and, if necessary, portable within the workplace. Visibility: Containers should be visible to the workers who use them. Workers should be able to see the degree to which the container is full (for plastic containers only). Accommodation: Container designs should be convenient, environmentally sound, and easy to store. 11.4 DISPOSAL OF LABORATORIES SPECIMENS All laboratory specimens should be considered as „Potentially infectious‟. „BIOHAZARD‟ stickers should be placed on all such specimen and request forms. 11.5 MANAGEMENT OF USED LENIN Put all linen soiled with blood or body secretions, in isolation bag then in red plastic bag for laundry return. 11.6 MANAGEMENT OF REUSABLE INSTRUMENT All instruments soiled with blood or body fluids should be put first in isolation bag and then in red plastic bag for central sterilized supply department (CSSD) return. In small facilities where CSSD does not exist a clear decontamination and sterilization policy should be developed in accordance with infection control principles and strictly adhered to. 12 PRESCRIBED AUTHORITY FOR MEDICAL WASTE MANAGEMENT 7 [(1) 8 [Save as otherwise provide, the prescribed authority for enforcement] of the provisions of these rules shall be the State Pollution Control Boards in respect of States and the Pollution Control Committees in respect of the Union Territories and all pending cases with a prescribed authority appointed earlier shall stand transferred to the concerned State Pollution Control Board, or as the case may be, the Pollution Control Committees]. 7 Substituted by Rule 4 of the Bio-Medical Waste (M & H) (Second Amendment) Rules, 2000 vide notification S.O.545(E), dated 2.6.2000. 8 Substituted by Rule 2 (a) of the Bio-Medical Waste (M&H) (Amendment) Rules, 2003 vide notification S.O.1069 (E), dated 17.9.2003.
  • 37.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 37 9 [(1A)The prescribed authority for enforcement of the provisions of these rules in respect of all health care establishments including hospitals, nursing homes, clinics, dispensaries, veterinary institutions, Animal houses, pathological laboratories and blood banks of the Armed Forces under the Ministry of Defence shall be the Director General, Armed Forces Medical Services]. (2) The prescribed authority for the State or Union Territory shall be appointed within one month of the coming into force of these rules. (3) The prescribed authority shall function under the supervision and control of the respective Government of the State or Union Territory. (4) The prescribed authority shall on receipt of Form I make such enquiry as it deems fit and if it is satisfied that the applicant possesses the necessary capacity to handle bio-medical waste in accordance with these rules, grant or renew an authorisation as the case may be. (5) An authorisation shall be granted for a period of three years, including an initial trial period of one year from the date of issue. Thereafter, an application shall be made by the occupier/operator for renewal. All such subsequent authorisation shall be for a period of three years. A provisional authorisation will be granted for the trial period, to enable the occupier/operator to demonstrate the capacity of the facility. (6) The prescribed authority may after giving reasonable opportunity of being heard to the applicant and for reasons thereof to be recorded in writing, refuse to grant or renew authorisation. (7) Every application for authorisation shall be disposed of by the prescribed authority within ninety days from the date of receipt of the application. (8) The prescribed authority may cancel or suspend an authorisation, if for reasons, to be recorded in writing, the occupier/operator has failed to comply with any provision of the Act or these rules : Provided that no authorisation shall be cancelled or suspended without giving a reasonable opportunity to the occupier/operator of being heard. 9 Inserted sub-rule (1A) by Rule 2(b), ibid.
  • 38.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 38 13 AUTHORISATION AUTHORITIES OF MEDICAL WASTE  Every occupier of an institution generating, collecting, receiving, storing, transporting, treating, disposing and/or handling bio-medical waste in any other manner, except such occupier of clinics, dispensaries, pathological laboratories, blood banks providing treatment/service to less than 1000 (one thousand) patients per month, shall make an application in Form I to the prescribed authority for grant of authorisation.  Every operator of a bio-medical waste facility shall make an application in Form I to the prescribed authority for grant of authorisation.  Every application in Form I for grant of authorisation shall be accompanied by a fee as may be prescribed by the Government of the State or Union Territory.  10[(4)The authorisation to operate a facility shall be issued in Form IV, subject to conditions laid therein and such other condition, as the prescribed authority, may consider it necessary.] 14 MAINTAINANCE OF RECORDS  Every authorised person shall maintain records related to the generation, collection, reception, storage, transportation, treatment, disposal and/or any form of handling of bio- medical waste in accordance with these rules and any guidelines issued.  All records shall be subject to inspection and verification by the prescribed authority at any time. 15 GUIDELINES BY CPCB FOR MEDICAL WASTE TREATMENT PLANT  A common bio-medical waste treatment facility (cbwtf) is a set up which has been legally introduced in India.  It is a set up where bio-medical waste, generated from a number of healthcare units, is imparted necessary treatment to reduce adverse effects that this waste may pose.  The treated waste may finally be sent for disposal in a landfill or for recycling purposes. 10 Inserted by Rule 5 of the Bio-Medical Waste (M&H) (Second Amendment) Rules, 2000 vide notification S.O.545(E), dated 2.6.2000.
  • 39.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 39  Installation of individual treatment facilities by small healthcare units requires comparatively high capital investment. In addition, it requires separate manpower and infrastructure development for proper operation and maintenance of treatment systems.  The concept of cbwtf not only addresses such problems but also prevents proliferation of treatment equipment in a city. In turn it reduces the monitoring pressure on regulatory agencies.  Its considerable advantages have made cbwtf popular and proven concept in many developed countries. 15.1 LOCATION OF A CBWTF  A cbwtf shall be located far away from residential and sensitive area so that it has minimal impact on these areas.  Near to its area of operation as possible in order to minimize the travel distance in waste collection, thus enhancing its operational flexibility.  The location shall be decided in consultation with the state pollution control board (spcb)/pollution control committee (pcc). 15.2 LAND REQUIREMENT It is felt that a cbwtf will require minimum of 1 acre land area to provide all required systems. 15.3 COVERAGE AREA OF CBWTF  In any area, only one cbwtf may be allowed to cater up to 10,000 beds.  A cbwtf shall not be allowed to cater healthcare units situated beyond a radius of 150 km.
  • 40.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 40 16 CONCLUSION AND RECOMMENDATION After doing this dissertation and going through all the studies I concluded that there are various laws, standards, rules and regulations prescribed for medical waste management i.e. for segregation of medical waste, handling of medical waste, holding of waste in a hospital compound, disposal of waste and the treatment technologies for different type of medical wastes. But there is still lack of compliance of medical waste management rules and regulations in the practical field. As the segregation of waste at the time of generation is not done properly or efficiently this leads to the risk of infections to the patients as well as for the other people or staff in the hospital premises. The litter bins for different types of wastes are sometimes placed to the close vicinity of the waiting areas where there is always a high risk to the people of getting infected from dangerous diseases. Lying of waste here and there without being concealed in the respective color coded bags can also be seen in various health care facilities this is just due to the ignorance attitude of the staff members involved in management of medical waste. So, there is a special need of introducing various new technologies in management of medical waste to reduce the human interventions and therefore reducing the risk for staff members and most importantly to avoid the mistakes done by the or made by the human personnel in managing the waste. 16.1 RECOMMENDATION The recommendation includes the providing of small litter bins close to the place from where the waste is generated but in the enclosed area to avoid the chances of spreading the infections in the vicinity of hospitals. The introduction of RFID (RADIO FREQUENCY IDENTIFICATION) in managing of medical waste can also be done to manage the waste easily and efficiently. RFID is a real time tracking tool that can automatically retrieve pre-stored data without human intervention. Radio frequency identification technology offers tracking capability to locate equipment and people in real time. It uses radio waves for data collection and transfer. RFID tag is a small object, such as an adhesive sticker, that can be attached to or incorporated into a product. So, this is all that I want to recommend for the management of medical waste and making this management more efficient so as to reduce the risks from medical waste.
  • 41.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 41 Bibliography (1998). THE BIO-MEDICAL WASTE (MANAGEMENT AND HANDLING) RULES,. New Delhi: MINISTRY OF ENVIRONMENT & FORESTS. Color Coding of wastes. (n.d.). Retrieved from www.envirovigil- bmwm.com/Management/Segregation.html CPCB. (n.d.). Bio-Medical Waste. parivesh. Health Care Waste Management. (n.d.). Retrieved from https://www.gov.uk/healthcare-waste Leybovich, F. (2012). Medical Waste Management. WHO. (2011). Waste from health-care activities. C Lee, George Huffman, and Richard Nalesnik Environmental Science & Technology 1991 25 (3), 360- 363 Links http://en.wikipedia.org/wiki/Biomedical_waste https://www.gov.uk/healthcare-waste http://www.who.int/topics/medical_waste/en/ www.healthcarewaste.org/
  • 42.
    MEDICAL WASTE MANAGEMENT ISHITBHARADWAJ /M.ARCH (MEDICAL ARCHITECTURE) /1ST SEM Page 42
