                                                                                Page 2

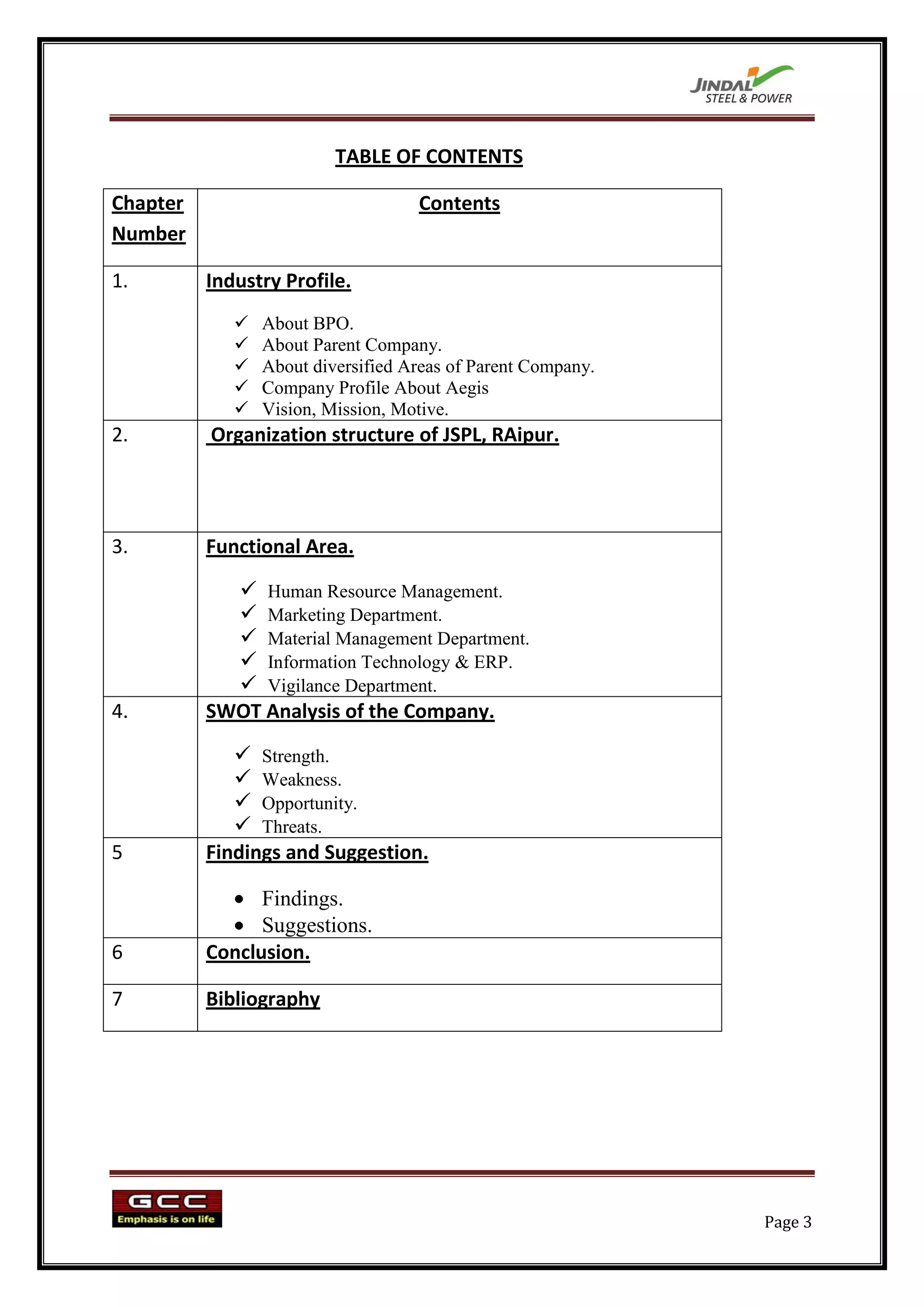

TABLE OF CONTENTS

Chapter                             Contents
Number

1.        Industry Profile.
                About BPO.
                About Parent Company.
                About diversified Areas of Parent Company.
                Company Profile About Aegis
                Vision, Mission, Motive.
2.        Organization structure of JSPL, RAipur.

3.        Functional Area.

             Human Resource Management.
             Marketing Department.
             Material Management Department.
             Information Technology & ERP.
             Vigilance Department.
4.        SWOT Analysis of the Company.

              Strength.
              Weakness.
              Opportunity.
              Threats.
5         Findings and Suggestion.

                Findings.
                Suggestions.
6         Conclusion.

7         Bibliography

                                                              Page 3
Page 4
Page 5

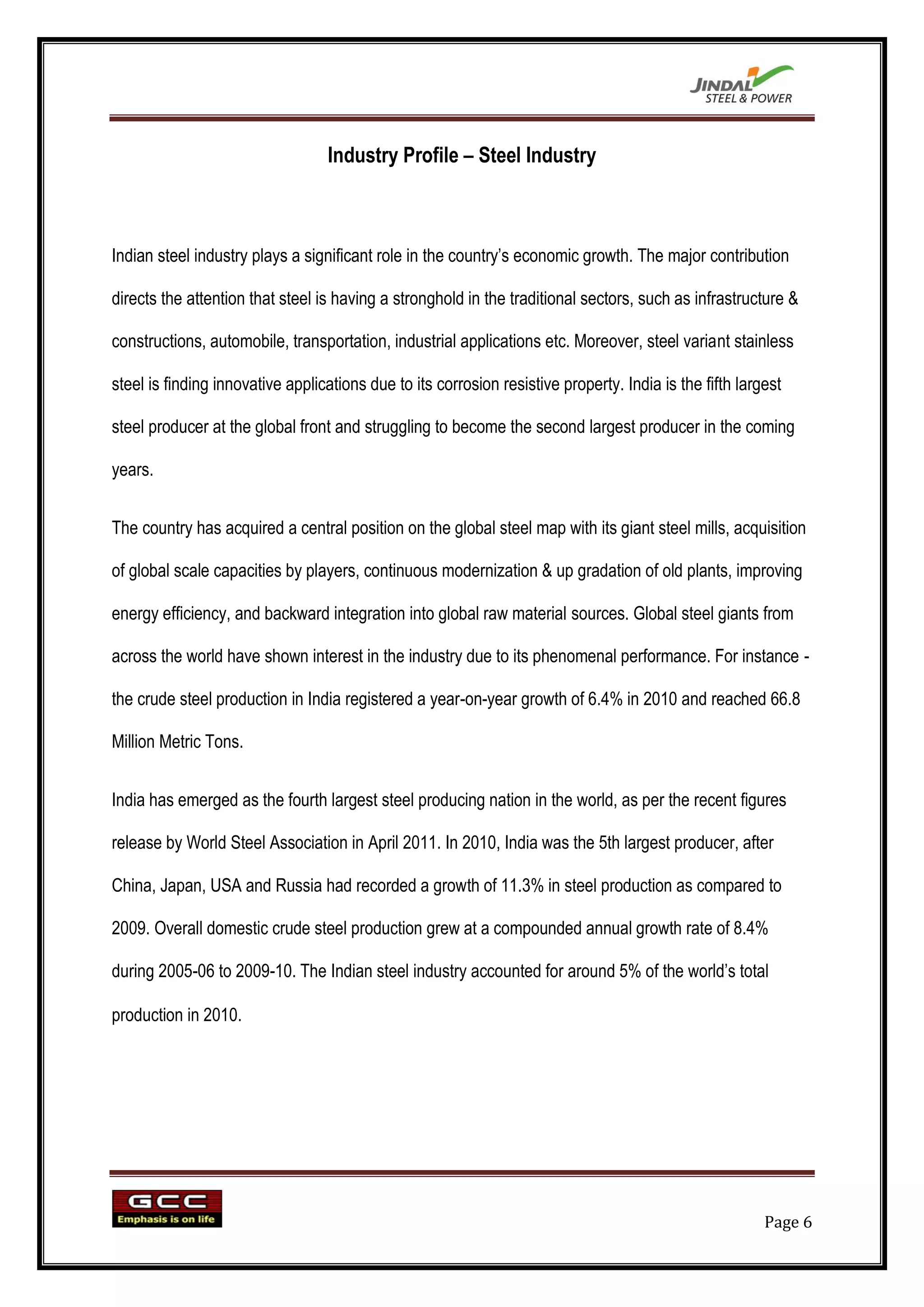

Industry Profile – Steel Industry

Indian steel industry plays a significant role in the country‟s economic growth. The major contribution

directs the attention that steel is having a stronghold in the traditional sectors, such as infrastructure &

constructions, automobile, transportation, industrial applications etc. Moreover, steel variant stainless

steel is finding innovative applications due to its corrosion resistive property. India is the fifth largest

steel producer at the global front and struggling to become the second largest producer in the coming

years.

The country has acquired a central position on the global steel map with its giant steel mills, acquisition

of global scale capacities by players, continuous modernization & up gradation of old plants, improving

energy efficiency, and backward integration into global raw material sources. Global steel giants from

across the world have shown interest in the industry due to its phenomenal performance. For instance -

the crude steel production in India registered a year-on-year growth of 6.4% in 2010 and reached 66.8

Million Metric Tons.

India has emerged as the fourth largest steel producing nation in the world, as per the recent figures

release by World Steel Association in April 2011. In 2010, India was the 5th largest producer, after

China, Japan, USA and Russia had recorded a growth of 11.3% in steel production as compared to

2009. Overall domestic crude steel production grew at a compounded annual growth rate of 8.4%

during 2005-06 to 2009-10. The Indian steel industry accounted for around 5% of the world‟s total

production in 2010.

                                                                                                         Page 6

new research report “Indian Steel Industry Outlook to 2012” says that the, Indian crude steel

production will grow at a CAGR of around 10% during 2010-2013. Moreover, with the government

proactive incentive plans to boost economic growth by injecting funds in various industries, such as

construction, infrastructure, automobile, and power will drive the steel industry in future. The report also

reveals that, steel consumption in India is expected to grow significantly in coming years as per capita

finished steel consumption is far less than its regional counterparts.

The demand for steel in the country is currently growing at the rate of over 8% and it is expected that

the demand would grow over by 10% in the next five years. However, the steel intensity in the country

remains well below the world levels. Our per capita consumption of steel is around 110 pounds as

compared to 330 Pounds for the global average. This indicates that there is a lot of potential for

increasing the steel consumption in India.

Immense growth potential in Indian Steel Sector

Domestic crude steel production grew at a compounded annual growth rate of 8.4% in the last few

years.

Crude steel production capacity of the country is projected to be around 110 million tonne by 2012-13.

222 Memorandum of Understandings (MOU) have been signed with various states for planned capacity

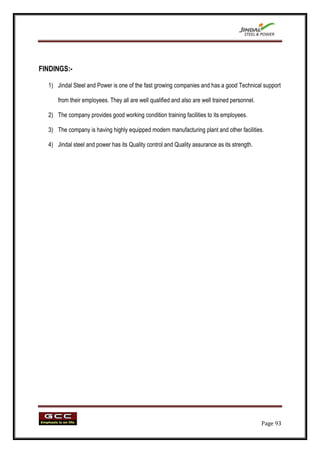

of around 276 million tonnes by 2019-20.

Investments at stake are to the tune of $187 billion in the Steel sector.

Increase in the demand of steel in India is expected to be 14% against the global average of 5-6% due

to its strong domestic economy, massive infrastructure needs and expansion of industrial production.

                                                                                                     Page 7

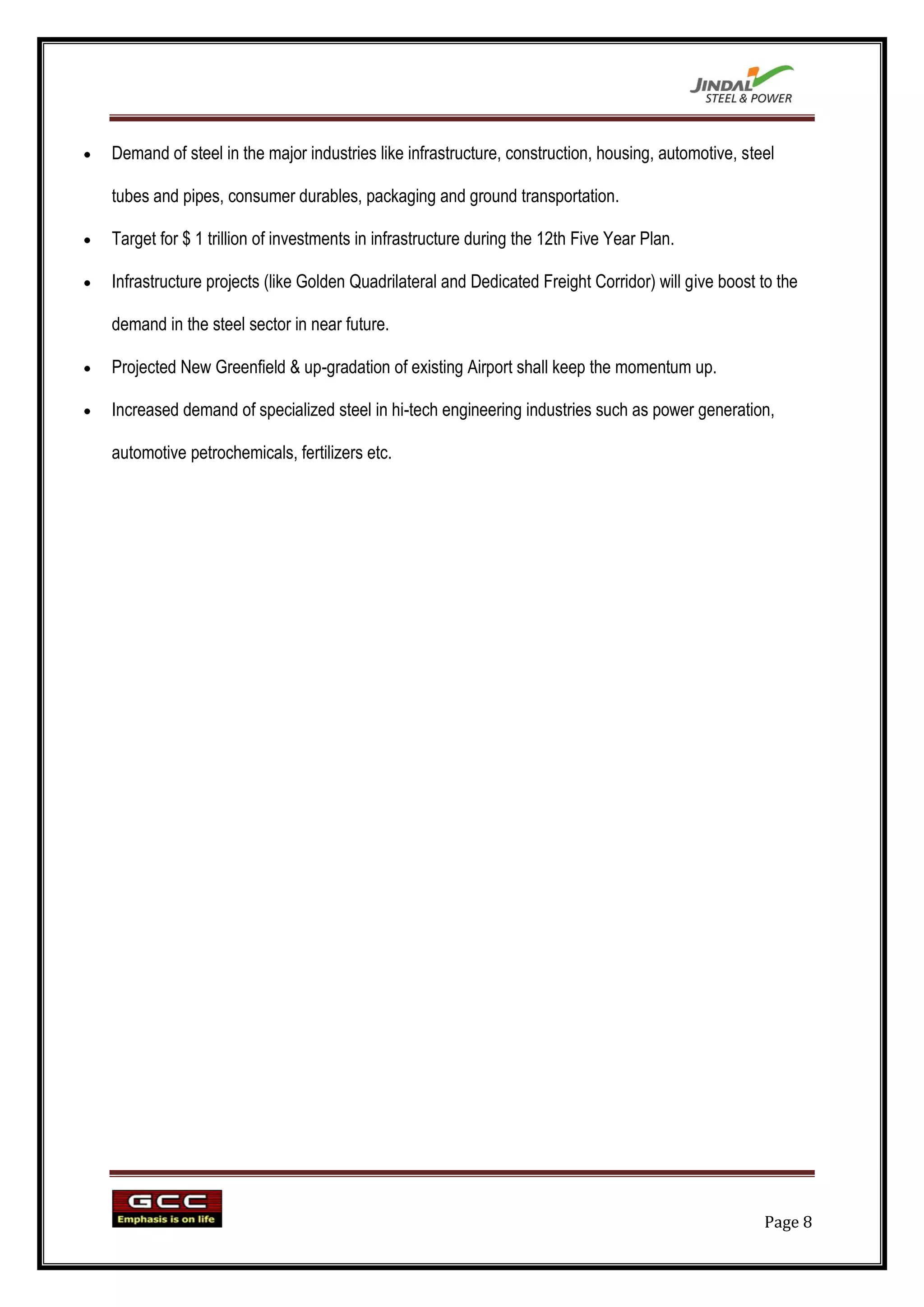

Demand of steel in the major industries like infrastructure, construction, housing, automotive, steel

tubes and pipes, consumer durables, packaging and ground transportation.

Target for $ 1 trillion of investments in infrastructure during the 12th Five Year Plan.

Infrastructure projects (like Golden Quadrilateral and Dedicated Freight Corridor) will give boost to the

demand in the steel sector in near future.

Projected New Greenfield & up-gradation of existing Airport shall keep the momentum up.

Increased demand of specialized steel in hi-tech engineering industries such as power generation,

automotive petrochemicals, fertilizers etc.

                                                                                                   Page 8
Page 9

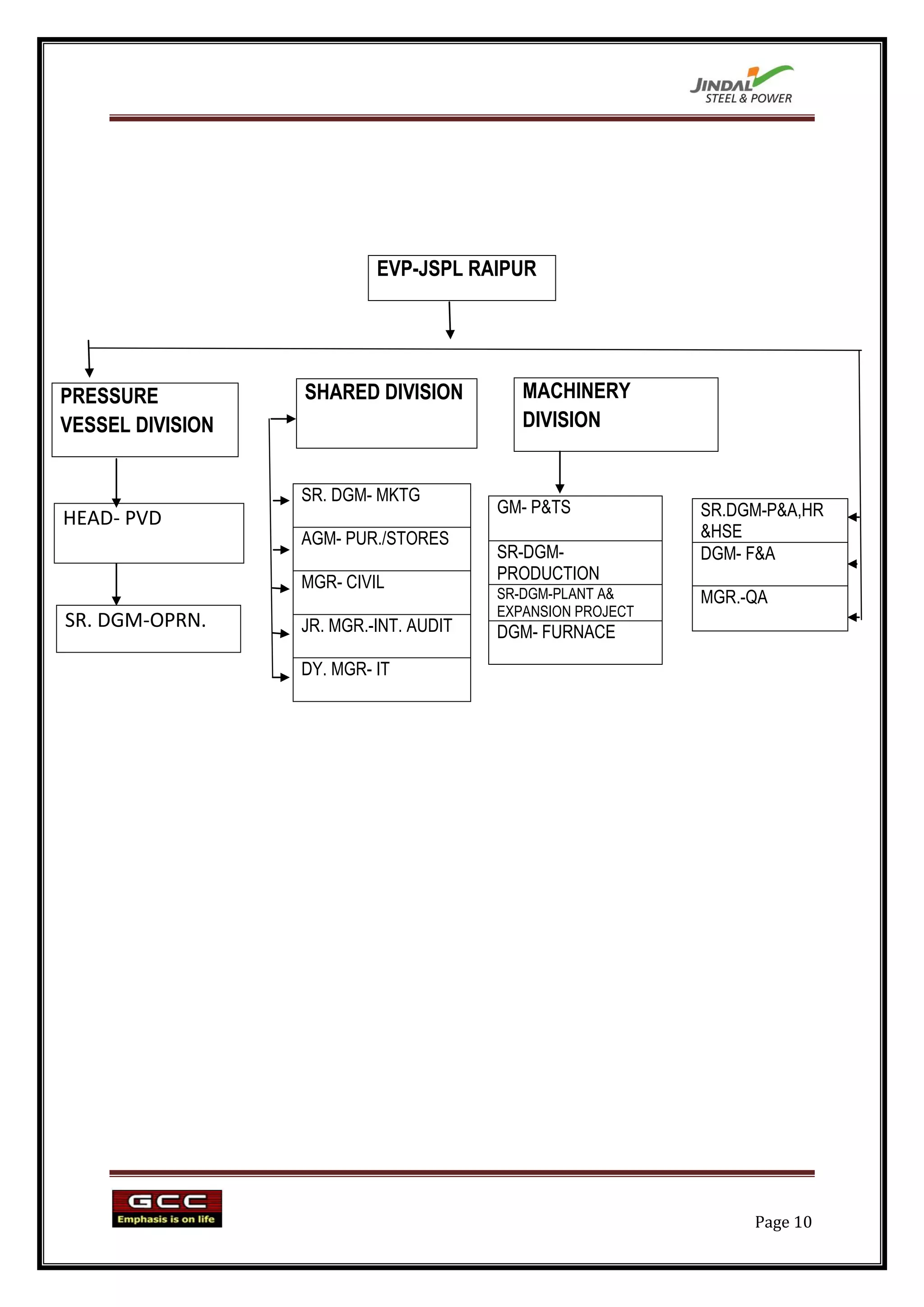

EVP-JSPL RAIPUR

PRESSURE          SHARED DIVISION          MACHINERY
VESSEL DIVISION                            DIVISION

                  SR. DGM- MKTG
                                        GM- P&TS            SR.DGM-P&A,HR
HEAD- PVD
                  AGM- PUR./STORES                          &HSE
                                        SR-DGM-             DGM- F&A
                  MGR- CIVIL            PRODUCTION
                                        SR-DGM-PLANT A&     MGR.-QA
                                        EXPANSION PROJECT
SR. DGM-OPRN.     JR. MGR.-INT. AUDIT   DGM- FURNACE
                  DY. MGR- IT

                                                                 Page 10
Page 11

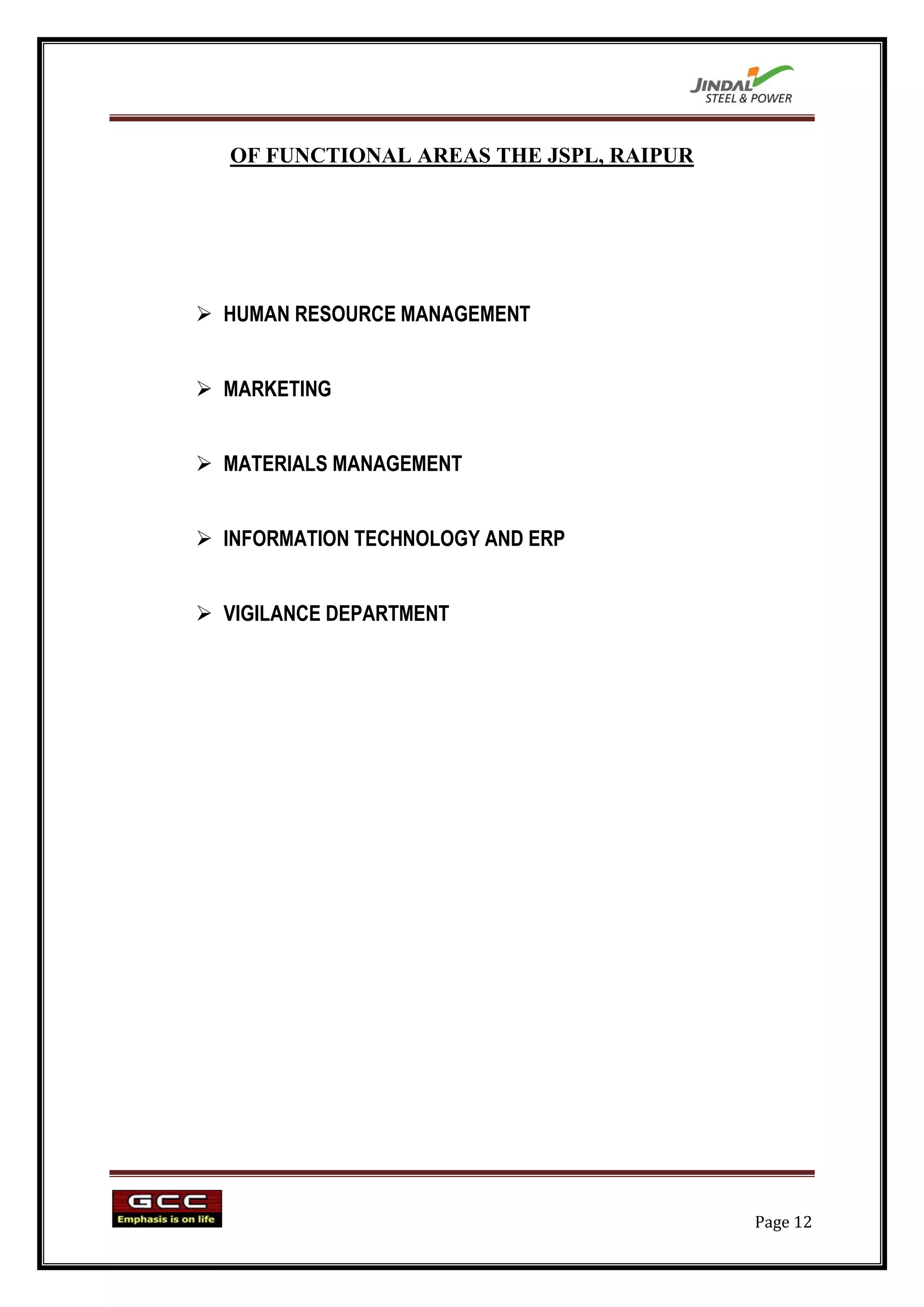

OF FUNCTIONAL AREAS THE JSPL, RAIPUR

 HUMAN RESOURCE MANAGEMENT

 MARKETING

 MATERIALS MANAGEMENT

 INFORMATION TECHNOLOGY AND ERP

 VIGILANCE DEPARTMENT

                                         Page 12

HUMAN RESOURCE DEVELOPMENT

Human Resource Development (HRD) is the frameworks for helping employees develop their
personal and organizational skills, knowledge, and abilities. Human Resource Development
includes such opportunities as employee training, employee career development, performance
management and development, coaching, mentoring, succession planning, key employee
identification, tuition assistance, and organization development.

The focus of all aspects of Human Resource Development is on developing the most superior
workforce so that the organization and individual employees can accomplish their work goals in
service to customers.

Organizations have many opportunities for human resources or employee development, both
within and outside of the workplace.
Human Resource Development can be formal such as in classroom training, a college course,
or an organizational planned change effort. Or, Human Resource Development can be informal
as in employee coaching by a manager. Healthy organizations believe in Human Resource
Development and cover all of these bases.
The field of HRD or Human Resource Development encompasses several aspects of enabling
and empowering human resources in organization. Whereas earlier HRD was denoted as
managing people in organizations with emphasis on payroll, training and other functions that
were designed to keep employees happy, the current line of management thought focuses on
empowering and enabling them to become employees capable of fulfilling their aspirations and
actualizing their potential. This shift in the way human resources are treated has come about
due to the prevailing notion that human resources are sources of competitive advantage and
not merely employees fulfilling their job responsibilities. The point here is that the current
paradigm in HRD treats employees as value creators and assets based on the RBV or the
Resource Based View of the firm that has emerged in the SHRM (Strategic Human Resource
Management) field.

The field of HRD spans several functions across the organization starting with employee
recruitment and training, appraisals and payroll and extending to the recreational and
motivational aspects of employee development.

Indeed, one reason for the emergence of the RBV or the SHRM paradigm is that with the
advent of the service sector and the greater proportion of companies in the service sector,
employees are not merely a factor of production like land, labour and capital but in fact, they
are sources of competitive advantage. This is characterized by many CEO‟s calling employees
their chief assets and valuing their contribution accordingly. As a matter of fact, many IT and

                                                                                       Page 13
Financial Services companies routinely refer to employees as the value creators and value
enhancers rather than just resources doing their job.

What this has meant is that the field of HRD has become prominent and important for
organizations and has morphed into a function that takes its place among other support
functions in organizations and indeed, it is the main driver of competitive advantage.

Further, the field of HRD now has taken on a role that goes beyond employee satisfaction and
instead, the focus now is on ensuring that employees are delighted with the working conditions
and perform their jobs according to their latent potential which is brought to the fore. This has
resulted in the HRD manager and the employees of the HRD department becoming partners in
the organization‟s progress instead of just yet another line function. Further, the HR managers
now routinely interact with the functional managers and the people managers to ensure high
levels of job satisfaction and fulfilment. The category of people managers is a role that has
been created in many multinational companies like Fidelity and IBM to specifically look into the
personality related aspects of employees and to ensure that they bring the best to the table.

Finally, HRD is no longer just about payroll or timekeeping and leave tracking. On the other
hand, directors of HRD in companies like Infosys are much sought after for their inputs into the
whole range of activities spanning the function and they are expected to add value rather than
just consume resources. With this introduction, we will be moving into the module covering
HRD with each aspect of the HRD function and the associated topics being covered here. It is
hoped that the readers would gain an overall perspective about HRD after going through the
HRD module.

This module covers the HRD function in organizations from a wide variety of perspectives. At
the outset, after the introduction to the module in the previous article, it is time to look at some
theoretical perspectives about the HRD function. When the field of management science and
organizational behaviour was in its infancy, the HRD function was envisaged as a department
whose sole role was to look after payroll and wage negotiation. This was in the era of the
assembly line and manufacturing where the HRD function‟s purpose was to check the
attendance of the employees, process their pay and benefits and act as a mediator in disputes
between the management and the workers. Concomitant with the rise of the services sector
and the proliferation of technology and financial services companies, the role of the HRD
function changed correspondingly.

For instance, the RBV or the Resource Based View of organizations was conceptualized to
place the HRD function as a department that would leverage the human resources from the
perspective of them being sources of strategic advantage.

                                                                                            Page 14
The shift in the way the human resources were viewed as yet another factor of production to
being viewed as sources of competitive advantage and the chief determinant of profits was
mainly due to the changing perceptions of the workforce being central to the organization‟s
strategy. For instance, many software and tech companies as well as other companies in the
service sector routinely identify their employees as the chief assets and something that can
give them competitive advantage over their rivals. Hence, the HRD function in these sectors
has evolved from basic duties and is now looked upon as a critical support function.

With the advent of globalization and the opening up of the economies of several nations, there
was again a shift in the way the HRD function was conceptualized. In line with the RBV and the
view of the resources as being international and ethnically diverse, the HRD function was
thought of to be the bridge between the different employees in multiple locations and the
management. Further, the present conceptualization also means that employees have to be
not only motivated but also empowered and enabled to help them actualize their potential. The
point here is that no longer were employees being treated like any other asset. On the contrary,
they were the centre of attraction and attention in the changed paradigm. This called for the
HRD function to be envisaged as fulfilling a role that was aimed at enabling and empowering
employees instead of being just mediators and negotiators.

Finally, the theory of HRD also morphed with the times and in recent years, there has been a
perceptible shift in the way the HRD function has come to encompass the gamut of activities
ranging from routine tasks like hiring and training and payroll to actually being the function that
plays a critical and crucial role in the employee development. The theory has also transformed
the function from being bystanders to the organizational processes to one where the HRD
function is the layer between the management and employees to ensure that the decisions
made at the top are communicated to the employees and the feedback from the employees is
likewise communicated to the top

PERSONNEL MANAGEMENT

Personnel management can be defined as obtaining, using and maintaining a satisfied
workforce. It is a significant part of management concerned with employees at work and with
their relationship within the organization.

According to Flippo, “Personnel management is the planning, organizing, compensation,
integration and maintainance of people for the purpose of contributing to organizational,
individual and societal goals.”

                                                                                           Page 15
According to Brech, “Personnel Management is that part which is primarily concerned with
human resource of organization.”

NATURE OF PERSONNEL MANAGEMENT

1.        Personnel management includes the function of employment, development and
compensation- These functions are performed primarily by the personnel management in
consultation with other departments.
2.        Personnel management is an extension to general management. It is concerned with
promoting and stimulating competent work force to make their fullest contribution to the
concern.
3.        Personnel management exist to advice and assist the line managers in personnel
matters. Therefore, personnel department is a staff department of an organization.
4.        Personnel management lays emphasize on action rather than making lengthy
schedules, plans, work methods. The problems and grievances of people at work can be
solved more effectively through rationale personnel policies.
5.        It is based on human orientation. It tries to help the workers to develop their potential
fully to the concern.
6.        It also motivates the employees through it‟s effective incentive plans so that the
employees provide fullest co-operation.
7.        Personnel management deals with human resources of a concern. In context to human
resources, it manages both individual as well as blue- collar workers.

ROLE OF PERSONNEL MANAGER

Personnel manager is the head of personnel department. He performs both managerial and
operative functions of management. His role can be summarized as :
1.       Personnel manager provides assistance to top management- The top management are
the people who decide and frame the primary policies of the concern. All kinds of policies
related to personnel or workforce can be framed out effectively by the personnel manager.
2.       He advices the line manager as a staff specialist- Personnel manager acts like a staff
advisor and assists the line managers in dealing with various personnel matters.
3.       As a counsellor,- As a counsellor, personnel manager attends problems and
grievances of employees and guides them. He tries to solve them in best of his capacity.
4.       Personnel manager acts as a mediator- He is a linking pin between management and
workers.
5.       He acts as a spokesman- Since he is in direct contact with the employees, he is
required to act as representative of organization in committees appointed by government. He
represents company in training programmes.

                                                                                          Page 16
FUNCTIONS OF PERSONNEL MANAGEMENT

Following are the four functions of Personnel Management:
1.     Manpower Planning
2.     Recruitment
3.     Selection
4.     Training and Development

Manpower Planning which is also called as Human Resource Planning consists of putting right
number of people, right kind of people at the right place, right time, doing the right things for
which they are suited for the achievement of goals of the organization. Human Resource
Planning has got an important place in the arena of industrialization. Human Resource
Planning has to be a systems approach and is carried out in a set procedure. The procedure is
as follows:
1.       Analyzing the current manpower inventory
2.       Making future manpower forecasts
3.       Developing employment program
4.       Design training program

STEPS IN MANPOWER PLANNING

1. Analyzing the current manpower inventory- Before a manager makes forecast of future
manpower, the current manpower status has to be analyzed. For this the following things have
to be noted-
•       Type of organization
•       Number of departments
•       Number and quantity of such departments
•       Employees in these work units

Once these factors are registered by a manager, he goes for the future forecasting.
2.       Making future manpower forecasts- Once the factors affecting the future manpower
forecasts are known, planning can be done for the future manpower requirements in several
work units.
The Manpower forecasting techniques commonly employed by the organizations are as
follows:

a. Expert Forecasts: This includes informal decisions, formal expert surveys and Delphi
technique.

                                                                                         Page 17
b. Trend Analysis: Manpower needs can be projected through extrapolation (projecting past
trends), indexation (using base year as basis), and statistical analysis (central tendency
measure).

c. Work Load Analysis: It is dependent upon the nature of work load in a department, in a
branch or in a division.

d. Work Force Analysis: Whenever production and time period has to be analysed, due
allowances have to be made for getting net manpower requirements.

e. Other methods: Several Mathematical models, with the aid of computers are used to forecast
manpower needs, like budget and planning analysis, regression, new venture analysis.

3. Developing employment program- Once the current inventory is compared with future
forecasts, the employment program can be framed and developed accordingly, which will
include recruitment, selection procedures and placement plans.

4. Design training program - These will be based upon extent of diversification, expansion
plans, development program ,etc. Training program depend upon the extent of improvement in
technology and advancement to take place. It is also done to improve upon the skills,
capabilities, knowledge of the workers.

IMPORTANCE OF MANPOWER PLANNING

1. Key to managerial functions- The four managerial functions, i.e., planning, organizing,
directing and controlling are based upon the manpower. Human resources help in the
implementation of all these managerial activities. Therefore, staffing becomes a key to all
managerial functions.

2. Efficient utilization- Efficient management of personnels becomes an important function in
the industrialization world of today. Setting of large scale enterprises require management of
large scale manpower. It can be effectively done through staffing function.

3.       Motivation- Staffing function not only includes putting right men on right job, but it also
comprises of motivational programmes, i.e., incentive plans to be framed for further
participation and employment of employees in a concern. Therefore, all types of incentive plans
becomes an integral part of staffing function.

                                                                                           Page 18

4.       Better human relations- A concern can stabilize itself if human relations develop and
are strong. Human relations become strong trough effective control, clear communication,
effective supervision and leadership in a concern. Staffing function also looks after training and
development of the work force which leads to co-operation and better human relations.

5.      Higher productivity- Productivity level increases when resources are utilized in best
possible manner. Higher productivity is a result of minimum wastage of time, money, efforts
and energies. This is possible through the staffing and its related activities (Performance
appraisal, training and development, remuneration)

NEED OF MANPOWER PLANNING

Manpower Planning is a two-phased process because manpower planning not only analyses
the current human resources but also makes manpower forecasts and thereby draw
employment programmes.
Manpower Planning is advantageous to firm in following manner:
1.      Shortages and surpluses can be identified so that quick action can be taken wherever
required.

2.      All the recruitment and selection programmes are based on manpower planning.

3.      It also helps to reduce the labour cost as excess staff can be identified and thereby
overstaffing can be avoided.

4.     It also helps to identify the available talents in a concern and accordingly training
program can be chalked out to develop those talents.

5.      It helps in growth and diversification of business. Through manpower planning, human
resources can be readily available and they can be utilized in best manner.

6.       It helps the organization to realize the importance of manpower management which
ultimately helps in the stability of a concern.

                                                                                          Page 19

TYPES OF RECRUITMENT:

1. INTERNAL RECRUITMENT - is a recruitment which takes place within the concern or
organization. Internal sources of recruitment are readily available to an organization. Internal
sources are primarily three - Transfers, promotions and Re-employment of ex-employees. Re-
employment of ex-employees is one of the internal sources of recruitment in which employees
can be invited and appointed to fill vacancies in the concern. There are situations when ex-
employees provide unsolicited applications also.
Internal recruitment may lead to increase in employee‟s productivity as their motivation level
increases. It also saves time, money and efforts. But a drawback of internal recruitment is that
it refrains the organization from new blood. Also, not all the manpower requirements can be
met through internal recruitment. Hiring from outside has to be done.
Internal sources are primarily 3 types
a.        Transfers
b.        Promotions (through Internal Job Postings) and
c.        Re-employment of ex-employees - Re-employment of ex-employees is one of the
internal sources of recruitment in which employees can be invited and appointed to fill
vacancies in the concern. There are situations when ex-employees provide unsolicited
applications also.

2. EXTERNAL RECRUITMENT - External sources of recruitment have to be solicited from
outside the organization. External sources are external to a concern. But it involves lot of time
and money. The external sources of recruitment include - Employment at factory gate,
advertisements, employment exchanges, employment agencies, educational institutes, labor
contractors, recommendations etc.

a.       Employment at Factory Level - This a source of external recruitment in which the
applications for vacancies are presented on bulletin boards outside the Factory or at the Gate.
This kind of recruitment is applicable generally where factory workers are to be appointed.
There are people who keep on soliciting jobs from one place to another. These applicants are
called as unsolicited applicants. These types of workers apply on their own for their job. For this
kind of recruitment workers have a tendency to shift from one factory to another and therefore
they are called as “badli” workers.

b.      Advertisement - It is an external source which has got an important place in
recruitment procedure. The biggest advantage of advertisement is that it covers a wide area of
market and scattered applicants can get information from advertisements. Medium used is
Newspapers and Television.

c.     Employment Exchanges - There are certain Employment exchanges which are run by
government. Most of the government undertakings and concerns employ people through such

                                                                                          Page 20
exchanges. Now-a-days recruitment in government agencies has become compulsory through
employment exchange.
d.      Employment Agencies - There are certain professional organizations which look
towards recruitment and employment of people, i.e. these private agencies run by private
individuals supply required manpower to needy concerns.

e.      Educational Institutions - There are certain professional Institutions which serves as an
external source for recruiting fresh graduates from these institutes. This kind of recruitment
done through such educational institutions is called as Campus Recruitment. They have special
recruitment cells which help in providing jobs to fresh candidates.

f.        Recommendations - There are certain people who have experience in a particular
area. They enjoy goodwill and a stand in the company. There are certain vacancies which are
filled by recommendations of such people. The biggest drawback of this source is that the
company has to rely totally on such people which can later on prove to be inefficient.

g.       Labour Contractors - These are the specialist people who supply manpower to the
Factory or Manufacturing plants. Through these contractors, workers are appointed on contract
basis, i.e. for a particular time period. Under conditions when these contractors leave the
organization, such people who are appointed have to also leave the concern.

Employee Selection is the process of putting right men on right job. It is a procedure of
matching organizational requirements with the skills and qualifications of people. Effective
selection can be done only when there is effective matching. By selecting best candidate for
the required job, the organization will get quality performance of employees. Moreover,
organization will face less of absenteeism and employee turnover problems. By selecting right
candidate for the required job, organization will also save time and money. Proper screening of
candidates takes place during selection procedure. All the potential candidates who apply for
the given job are tested.
But selection must be differentiated from recruitment, though these are two phases of
employment process. Recruitment is considered to be a positive process as it motivates more
of candidates to apply for the job. It creates a pool of applicants. It is just sourcing of data.
While selection is a negative process as the inappropriate candidates are rejected here.
Recruitment precedes selection in staffing process. Selection involves choosing the best
candidate with best abilities, skills and knowledge for the required job.

The Employee selection Process takes place in following order-

1. Preliminary Interviews- It is used to eliminate those candidates who do not meet the
minimum eligibility criteria laid down by the organization. The skills, academic and family

                                                                                         Page 21
background, competencies and interests of the candidate are examined during preliminary
interview. Preliminary interviews are less formalized and planned than the final interviews. The
candidates are given a brief up about the company and the job profile; and it is also examined
how much the candidate knows about the company. Preliminary interviews are also called
screening interviews.

2. Application blanks- The candidates who clear the preliminary interview are required to fill
application blank. It contains data record of the candidates such as details about age,
qualifications, reason for leaving previous job, experience, etc.

3. Written Tests- Various written tests conducted during selection procedure are aptitude test,
intelligence test, reasoning test, personality test, etc. These tests are used to objectively
assess the potential candidate. They should not be biased.

4. Employment Interviews- It is a one to one interaction between the interviewer and the
potential candidate. It is used to find whether the candidate is best suited for the required job or
not. But such interviews consume time and money both. Moreover the competencies of the
candidate cannot be judged. Such interviews may be biased at times. Such interviews should
be conducted properly. No distractions should be there in room. There should be an honest
communication between candidate and interviewer.
5.       Medical examination- Medical tests are conducted to ensure physical fitness of the
potential employee. It will decrease chances of employee absenteeism.
6.       Appointment Letter- A reference check is made about the candidate selected and then
finally he is appointed by giving a formal appointment letter.

Training of employees takes place after orientation takes place. Training is the process of
enhancing the skills, capabilities and knowledge of employees for doing a particular job.
Training process moulds the thinking of employees and leads to quality performance of
employees. It is continuous and never ending in nature.

IMPORTANCE OF TRAINING

Training is crucial for organizational development and success. It is fruitful to both employers
and employees of an organization. An employee will become more efficient and productive if he
is trained well.
Training is given on four basic grounds:
1.       New candidates who join an organization are given training. This training familiarize
them with the organizational mission, vision, rules and regulations and the working conditions.
2.       The existing employees are trained to refresh and enhance their knowledge.

                                                                                           Page 22
3.       If any updations and amendments take place in technology, training is given to cope up
with those changes. For instance, purchasing a new equipment, changes in technique of
production, computer implantment. The employees are trained about use of new equipments
and work methods.
4.       When promotion and career growth becomes important. Training is given so that
employees are prepared to share the responsibilities of the higher level job.
The benefits of training can be summed up as:
1.       Improves morale of employees- Training helps the employee to get job security and job
satisfaction. The more satisfied the employee is and the greater is his morale, the more he will
contribute to organizational success and the lesser will be employee absenteeism and
turnover.
2.       Less supervision- A well trained employee will be well acquainted with the job and will
need less of supervision. Thus, there will be less wastage of time and efforts.
3.       Fewer accidents- Errors are likely to occur if the employees lack knowledge and skills
required for doing a particular job. The more trained an employee is, the less are the chances
of committing accidents in job and the more proficient the employee becomes.
4.       Chances of promotion- Employees acquire skills and efficiency during training. They
become more eligible for promotion. They become an asset for the organization.
5.       Increased productivity- Training improves efficiency and productivity of employees.
Well trained employees show both quantity and quality performance. There is less wastage of
time, money and resources if employees are properly trained.

                   WAYS/METHODS OF TRAINING
        Training is generally imparted in two ways:

 On the job training- On the job training methods are those which are given to the employees
within the everyday working of a concern. It is a simple and cost-effective training method. The
in-proficient as well as semi- proficient employees can be well trained by using such training
method. The employees are trained in actual working scenario. The motto of such training is
“learning by doing.” Instances of such on-job training methods are job-rotation, coaching,
temporary promotions, etc.

Off the job training- Off the job training methods are those in which training is provided away
from the actual working condition. It is generally used in case of new employees. Instances of
off the job training methods are workshops, seminars, conferences, etc. Such method is costly
and is effective if and only if large number of employees have to be trained within a short time
period. Off the job training is also called as vestibule training, i.e., the employees are trained in

                                                                                             Page 23
a separate area( may be a hall, entrance, reception area, etc. known as a vestibule) where the
actual working conditions are duplicated

Training methods pertain to the types of training that can be provided to employees to sharpen
their existing skills and learn new skills. The skills that they learn can be technical or soft skills
and for all categories of skills, some training methods are suggested here. The training
methods can range from onsite classroom based ones, training at the office during which
employees might or not might check their work, experiential training methods which are
conducted in resorts and other places where there is room for experiential learning. Training
methods include many types of training tools and techniques and we shall discuss some of the
commonly employed tools and techniques. For instance, it is common for trainers to use a
variety of tools like visual and audio aids, study material, props and other enactment of scene
based material and finally, the experiential tools that include sports and exercise equipment.

If we take the first aspect of the different training methods that are location based, we would
infer from the explanation that these training methods include the specific location based ones
and would range from classroom training done at the trainers‟ location to the ones done on the
office premises.

Further, the experiential training methods can include use of resorts and other nature based
locations so that employees can get the experience of learning through practice or the act itself
rather than through study material. It needs to be remembered that the trainings conducted in
the office premises often involve employees taking breaks to check their work and hence might
not be ideal from the point of view of the organizations. However, provision can be done to
locate the training rooms away from the main buildings so that employees can be trained in a
relaxed manner. For instance, Infosys has training centres that are exclusively built for training
and these centres give the employees enough scope and time for learning new skills.

The next aspect of the training methods includes the use of visual and audio aids, study
material, props and equipment. Depending on the kind of training that is being imparted, there
can be a mechanism to use the appropriate tools and techniques based on the needs of the
trainers and the trainees. The use of the training material often indicates the thoroughness of
the training program and the amount of work that the trainers have put in to make the training
successful. Of course, if the training material is good, it also means that the employees would
benefit from the scope and depth of the material though they need to invest time and energy as
well.

Finally, the bottom line for any training to be successful is the synergy between the trainers and
the trainees and this is where the HRD function can act as a facilitator for effective trainings
and ensure that the trainers and trainees bond together and benefit in a mutual process of

                                                                                             Page 24
understanding and learning. In conclusion, there are various ways to approach trainings and
some of the methods discussed above would be good starting points for follow up action and
partnership between the training agencies and the organizations.

            AREAS OF PROGRAMMES AT HRD CENTRE:

            o NON EXECUTIVE

       ENHANCNG ENGINEERING SKILLS (MECHANICAL)
       ENHANCNG ENGINEERING SKILLS (ELETRICAL)
       MUTISKILL
       HYDRAULICS AND PUMP
       ELECTRONCS AND PLC
       COMPUTER
       UNIT TRAINING

            o EXECUTIVE

               COMPUTER
               MANAGERIAL GENERAL MANAGEMENT
               MANAGERIAL FUNCTION

                                                                                     Page 25
MARKETING DEPARTMENT

Marketing is defined as the process of determining the needs and wants of consumers and
being able to deliver products that satisfy those needs and wants. Marketing includes all of the
activities necessary to move a product from the producer to the consumer. Think of marketing
as a bridge
From the producer to the consumer. Marketing starts with market research, learning
process in which marketers get to know everything they can about the needs and wants of
consumers, and it ends when somebody buys something. Many companies feel that services
provided to customers after the purchase also are an important part of marketing. All of these
Enterprises -- production, advertising, transportation, processing, packaging, and selling -- are
included in the marketing process.

              THE NINE FUNCTIONS OF MARKETING

In order for the marketing bridge to work correctly -- providing consumers with opportunities to
purchase the products and services they need -- the marketing process must accomplish nine
important functions.

The functions are:

BUYING - people have the opportunity to buy products that they want.

SELLING - producers function within a free market to sell products to consumers.

FINANCING - banks and other financial institutions provide money for the production
and marketing of products.

STORAGE - products must be stored and protected until they are needed. This function
is especially important for perishable products such as fruits and vegetables.

TRANSPORTATION - products must be physically relocated to the locations where
consumers can buy them. This is a very important function. Transportation includes
rail road, ship, airplane, truck, and telecommunications for non-tangible products such
as market information.

PROCESSING - processing involves turning a raw product, like wheat, into something

                                                                                          Page 26
The consumer can use -- for example, bread.

RISK-TAKING - insurance companies provide coverage to protect producers and marketers
from loss due to fire, theft, or natural disasters.

MARKET INFORMATION - information from around the world about market conditions,
weather, price movements, and political changes, can affect the marketing process.
Market information is provided by all forms of telecommunication, such as television, the
internet, and phone.

GRADING AND STANDARDIZING - Many products are graded in order to conform to
previously determined standards of quality. For example, when you purchase US No. 1
Potatoes, you know you are buying the best potatoes on the market.

                      THE FOUR UTILITIES OF MARKETING

The marketing process must also add "utility" to the products consumers want. Utility is the
use or satisfaction a person gets from a product. If you purchase a chain saw you anticipate
that you will receive a certain amount of utility from it. You will be able to use the saw to cut fire
wood, prune trees, and take care of a variety of jobs around your home. There are four types
of utility.

FORM UTILITY - a product must be processed into a form that the customer wants or
needs. For example, wheat is processed into bread, trees are processed into
lumber, and potatoes are processed into French fries. If you ordered French fries
with your lunch and the waiter brought you a raw potato, you probably wouldn't be too happy.

PLACE UTILITY - place utility involves transporting products to the location where
consumers can buy them. If you live in Alaska, you certainly wouldn't want to have to
drive to California to buy oranges. Thanks to our modern transportation systems you
don't have to; you simply drive to the local grocery store and oranges are there ready
to add to your shopping cart -- place utility.

POSSESSION UTILITY - possession utility establishes legal ownership of a product. When
you purchase something you normally receive a receipt; this provides legal ownership
and the right to use the product. Some products, computer software, for example,
also provide a user license. A license of this kind gives you the right to use the product
within certain guidelines. Stocks prove that you own part of a company .This is an example of
Possession Utility.

                                                                                             Page 27

TIME UTILITY - this could be described as being in the right place at the right time when
a customer is ready to purchase a product. Creating and keeping customers means
having products available for when they want them, and often this requires some type
of storage facility. Wheat is one example of a commodity that must be stored after it is
harvested. It is stored in silos until processors are ready to convert it into food products
such as bread or cereals.

            MARKETING STRATEGIES OF STEEL INDUSTRY

Global marketing strategies are not standard product and market strategies that assume the
world to be a single. Global marketing strategies are also not about global presence or about
large companies. A company can very well operate in as many as countries, but if what it does
in one country has no meaning for what it does in the other country, it is no different from the
domestic companies. To qualify as pursuing global strategy a company needs to be able to
demonstrate two things:

1) It should be able to contest in any market it chooses to compete in.
2) It should be able to bring its entire resources to bear on any competitive situation it finds
itself in, regardless of where that might be.

The following are the main attributes of global marketing strategy:

1) Standard products and marketing mix: There is a need to aim for a standard core in the
product and to limit marketing adaptation to these aims. The more integrated the companies
become economically, the less latitude there is any way for things such as price discrimination
and channel selection. The same applies to situations where buyers themselves are global and
expect similar products and terms on a worldwide basis.

2) Sourcing assets and not just products: Sourcing products and components internationally
based has long been a feature of international business. However this attribute implies that
global marketing strategies are much about asset deployment for market access purpose as
they are about asset accumulation abroad.

3) Market access in line with breakeven: In order to be competent in the global market a
company need not be the biggest in its kind. Instead it should be able to generate the volume
of sales the required infrastructure demands.

4) Contesting assets: The other feature of global companies is it can neutralize the assets
and competencies of its competitors. For example, if a competitor is forced to switch from a

                                                                                            Page 28
low-cost to high-cost factory, it too can do so. Similarly if a competitor gains access to a new
        technology, it can do the same.

        5) Functions have a global orientation: The competition at the global market level is not just
        at the product or service level. It is also about building and maintain multinational infrastructure.

        The above five attributes taken together operational the global strategy.

        Conclusion: Global marketing strategies is gaining importance as more and more business
        organizations are looking to compete in the global market

                                   MARKETING OF JSPL

 Jindal Steel And Power Limited JSPL is India‟s leading steel maker presents the world of
steel..Backed by over five decades of experience of producing quality steel and creating the sinews of a
modern India.

        JSPL s five integrated steel plants (ISPs) produce the widest range of steel products that fulfil
        diverse needs of our customers.

        JSPL works closely with its customers understanding their needs and matching it with the right
        product. In case, you do not find your specific product here (by the laws of probability chances
        do exist, despite the fact that JSPL has the largest and widest products range in steel), and
        need something exclusive (in terms of quality, size, etc.) still, JSPL is the answer.

        For JSPLs dedicated R&D Centre, one of the most modern and largest in the country, it is an
        everyday affair to churn out customized products and JSPLs 5 ISPs give shape to their
        research capabilities.

        All this, to make every customer of JSPL steel feel special, and satisfied.

        JSPLs ongoing up-gradation and expansion program will further enhance our capability to add
        to JSPLs product basket and provide more special quality steel for niche industry needs.

                                                                                                    Page 29
ENLISTING NEW CUSTOMER INTO THE ORGANIZATION

            DETAILS REQUIRED FROM NEW CUSTOMERS

New customers desirous of starting import of Mild steel products of JSPL on sustained basis
are requested to send the following details/documents for enlistment.

1. Customer profile (Details of the customer / Firm) who will establish the Letter of Credit.
2. Name, Address, Telephone & Fax number, e-mail of the Contact person overseas and the
same of the representative in India (if any).
3. Last two years balance sheet of the company desirous of doing business with JSPL.
4. Name, address of the Bank through which the Letter of Credit will be established.
5. A certificate from the banker about business dealing with the customer

                                                                                       Page 30

MATERIALS DEPARTMENT

STORE KEEPING:
Store is an area of Materials Management Department and has an interface with many user
departments in its daily operations. The other areas being purchase, Inspection, PIVD, SRG etc,. The
basic purpose served by it, is the provision of uninterrupted service to production departments. Store is
the finishing area where materials management activities come to an end. The indenting of materials,
processing of indents, finalizing indents, procurement of materials with necessary formalities, inspection
of materials and finally the account and custody of materials are covered under the materials
management activities.

Arrival of materials at destinations, unloading them, arranging for their inspection (wherever necessary)
and finally taking account action together with custody , with the objective of efficiently and
economically providing the right material at the right time whenever required in the right condition to all
user departments are the Storekeeping functions.

Receiving the materials either at stores location or at users site, acceptance of the right material at the
right time are to be carefully carried out, so as to see that the supplier does not suffer from inordinate
delay both in unloading and account action. Similarly the internal customer i.e., the user departments
do not find any difficulty for drawl of materials in time.

The storekeeper in a store plays a vital role in all the above activities depending upon the duty allotted
to him by his controlling officers. The concern storekeepers looking after the various sections of the
stores are the key functionaries around which all the Storekeeping activities revolve.

The Storekeeper has to prepare a well co-ordinated plan and accordingly co-ordinate with all the
necessary agencies such as; the supplier, transporter, purchase, inspection, FM(M) and the laboratory
(if necessary) and the user departments. All the agencies do have their role to play as and when
approached by the store.

                                                                                                   Page 31
Storekeeping job though sounds much simple are an intricate job. The Storekeeper has to foresee,
visualize the shape of things to come in the days ahead wherein he has to function within limited
resources. Accordingly he decides and plans how to keep the materials where to keep them safely so
that they can be safely and securely issued to the user without any difficulty.

                         MATERIALS MANAGEMENT

The Stores Department is a part and parcel of the Materials Management Department, which is
functioning under the overall control of the Executive Director, Materials Management. The Stores
Department is headed by Deputy General Manager I/C (MM), Inspection & Stock Control, who is
assisted by DGM.(MM) Stores Administration, DGM.(Stock Control) and other executives of Stores
department. There are all together 21executives working in stores Department as on date.

There are Five Main Stores and Five Sub-Stores in Material Management Department of Rourkela
Steel Plant.

1.       CENTRAL STORES

2.       MODERNIZATION STORES

3.       REFRACTORY STORES

4.       PLANT STORES – II

5.       CSM STORES

6.       SUB –STORES:

               BLAST FURNACE SUB-STORES

               COLD ROLLING MILL SUB-STORES

               HOT STRIP MILL SUB-STORES

               SINTERING PLANT SUB-STORES

               TRAFFIC SUB-STORES

                                                                                             Page 32

As we know that Store keeping function is an inseparable part to any organization, whether industrial or
service oriented, public or private, small or large. Even though store keeping does not add any value to
the product in normal sense, it is an essential function and just cannot wished away. The Storekeeping
activities in Rourkela Steel Plant, are carried out according to the Stores Procedures, Standard
Operating Practices and Stores Manual. These activities are discussed in detail in the preceding
chapters.

                         MATERIAL RECEIPT & ACCOUNTING

Various material required in the plant are received various sources from outside which are verified and
accounted for in the Stores. Materials are received from various sources through various modes of
transportation. The major mode of transportation in our plant is receipt through Rail and Road. Other
than this the materials are received through courier, registered post or by hand also.

1.0     RECEIPT:
The receipt function is the last step in the Purchasing activity and the first link in the Stores Function.
This deals with the function of Receiving and physically handling delivered materials and verifying that
the delivery corresponds exactly as to the nature and quantity as per specified in Purchase Order.

The Storekeeping functions starts with the arrival of Consignments / Materials at the Material Gate i.e.
the Traffic Gate of JSPL. All incoming materials to the plant are physically checked for number of
Packets by CISF. The Stores representative i.e. the Storekeeper checks the validity of the delivery after
checking an on-line entry is made regarding A/T No., Challan No., Consignment Note (C/N), Type of
vehicle, Vehicle No. etc. in the Integrated Material Management System(IMMS) and the truck
movement permit is generated. Entry of materials at Traffic Gate is permitted between 8:30 am to 12:30
pm and 3:30 pm to 4:30 pm. The GARN Lead Time calculation is started from the time of Gate entry.

On reaching the materials at Stores, the representative of the Supplier / Transporter reports the Stores
Gate, where the documents are checked and entered into a register manually. The Central Store Gate
is computerised, where Data is picked-up from Traffic Gate entry. On giving the A/T No. only entry time
and receiving Bay location is fed in the system and correction / updation, if any, is also done here.

                                                                                                    Page 33

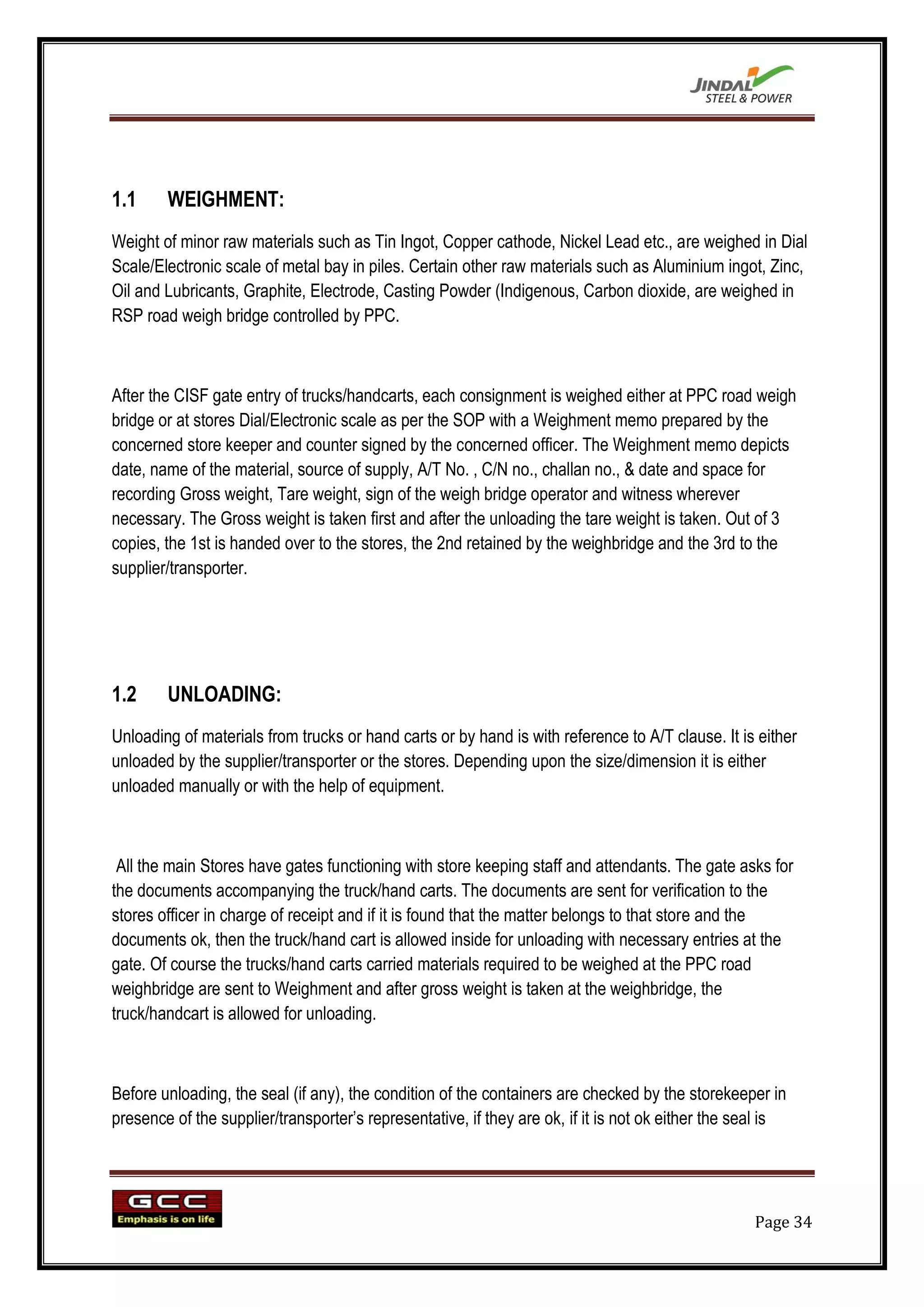

1.1     WEIGHMENT:
Weight of minor raw materials such as Tin Ingot, Copper cathode, Nickel Lead etc., are weighed in Dial
Scale/Electronic scale of metal bay in piles. Certain other raw materials such as Aluminium ingot, Zinc,
Oil and Lubricants, Graphite, Electrode, Casting Powder (Indigenous, Carbon dioxide, are weighed in
RSP road weigh bridge controlled by PPC.

After the CISF gate entry of trucks/handcarts, each consignment is weighed either at PPC road weigh
bridge or at stores Dial/Electronic scale as per the SOP with a Weighment memo prepared by the
concerned store keeper and counter signed by the concerned officer. The Weighment memo depicts
date, name of the material, source of supply, A/T No. , C/N no., challan no., & date and space for
recording Gross weight, Tare weight, sign of the weigh bridge operator and witness wherever
necessary. The Gross weight is taken first and after the unloading the tare weight is taken. Out of 3
copies, the 1st is handed over to the stores, the 2nd retained by the weighbridge and the 3rd to the
supplier/transporter.

1.2     UNLOADING:
Unloading of materials from trucks or hand carts or by hand is with reference to A/T clause. It is either
unloaded by the supplier/transporter or the stores. Depending upon the size/dimension it is either
unloaded manually or with the help of equipment.

 All the main Stores have gates functioning with store keeping staff and attendants. The gate asks for
the documents accompanying the truck/hand carts. The documents are sent for verification to the
stores officer in charge of receipt and if it is found that the matter belongs to that store and the
documents ok, then the truck/hand cart is allowed inside for unloading with necessary entries at the
gate. Of course the trucks/hand carts carried materials required to be weighed at the PPC road
weighbridge are sent to Weighment and after gross weight is taken at the weighbridge, the
truck/handcart is allowed for unloading.

Before unloading, the seal (if any), the condition of the containers are checked by the storekeeper in
presence of the supplier/transporter‟s representative, if they are ok, if it is not ok either the seal is

                                                                                                    Page 34
broken/missing, containers damaged, then suitable remarks are made on the challan/consignment note
with the supplier‟s/transporter representative‟s signature.

The concerned Bay store keeper (s) decides as to how and where the materials are to be unloaded. If
heavy consignment, then EOT crane or forklift has to be put on the job of unloading. The storekeeper
has to have a logistic approach while unloading keeping the accessibility, safe up-keep of the material,
self life in case of chemicals, susceptibility of being exposed to nature etc,.

1.3     DAY BOOKING :
After the materials are unloaded at the specified Bay/Yard, Day Booking is immediately taken up. In
case of weighable material it is only after tare weight is taken, Day booking taken place. Day booking
however in all cases is to be done within 24 hours. The details about the consignments are fed in the
IMMS on line. The A/T no., the document no., & date, the challan no., & date, no. of packages, quantity
CENVAT details, Way Bill no. & date are also entered online. Then automatically the Daybook is
allowed in the system and the Day book no. is allotted. The Daybook no. & date is recorded in the
consignment note/ challan/ invoice/Waybill etc. At the end of the day the printout of the entire Daybooks
raised in a section is taken up and put in the register. The D-3 declaration enclosing the EDGP and
Waybills (triplicate copies) are sent to F & A (stores bill) and Purchase respectively.

However incase of large consignment and materials having the storage facility at site, are sent directly
to user Departments for unloading only after raising of Day Book and Direct Delivery Note (DDN) at
Stores.

1.4     INSPECTION:
Inspection is a skilled operation and is done by specialised / trained personnel, proper testing facilities
and methods. The purpose of inspection is to ensure that that the materials delivered are the same as
those ordered, of the right quantity–dimensions, chemical characteristics etc., and are in proper
condition.

The Inspection is of two types like: - 1) Inspection at Stores and 2) Pre-dispatch Inspection. IN
Inspection at Stores; the concerned Storekeeper prepares a check report manually and put-up
physically to Inspection Department. Inspection Department deputes an Inspecting Officer, who
conducts the inspection after checking the documents required by A/T goes through TC / GC /MTC etc,

                                                                                                    Page 35
and checks the material delivered and they are according to the A/T stipulation then the case is passed
with the remarks “Inspected and Accepted” or else the case is rejected with qualifying remarks.

In Pre-dispatch Inspection; when the consignment arrives with pre – dispatch I/C (inspection certificate)
along with other documents, the concerned store-keeper checks dispatched from the loading points
with 45 days of issue of I/C and whether the material is having the suppliers identification the necessary
tag, seal, impression or embossment as mentioned in the I/C. In other words, the material is correlated
with the I/C, challan etc., with regard to the quantity in A/T requirement/ supplier‟s
identification/inspection‟s mark of certification then it is treated as OK and GARN is raised accepting the
material or else is rejected with reasons giving in the remarks column of the GARN.

Sometimes, joint inspection with user department is also conducted as per A/T terms, where lab test is
required. Sample is drawn by inspection in presence of Concerned Storekeeper for testing at Research
& Control Laboratory (RCL). After the test report, materials at inspection, acceptance or rejection GARN
is raised.

For Refractory items, where accounting is made in set, Day-booking is made after completion of supply
against sets. Since set consists of large volume of materials, supplies are made in number of
consignments in duration of some days. Refractory Stores maintains manual register for each such item
separately. All Invoice No., Challan No. with dates, items as per BOM with quantity, A/T no., supplier
are entered in the register. After completion of the supplies of all components of set of material, the
supplier gives the completion certificate (or otherwise) stores raises Day Booking and enters line items
against all such multiple invoice (one invoice with one or more items in one line entry) & one Daybook is
raised for multiple invoices.

In all cases, where Way-bill requirement exists, stores checks the second copy of Way-bill and sends
back to purchase through system generated memo. Submission of D-3 forms for Excisable goods: each
stores submits declaration of D-3 forms DFT copies of EDGP to Finance and Accounts Excise section,
after Day-booking.

         Modernization Stores receives Capital, AMR & Revenue items. AMR & Revenue items are
accounted and issued as per normal Stores Procedure against Stores Issue Note. In case of Project
items against a single Catalogue, multiple items are received in phases, as per BOM. The single supply
continues to a longer period till the project is completed. Inspection also carried out challan wise may
be at Firms premises or at Stores by Inspection. If required by the Project, material issued on manual

                                                                                                  Page 36

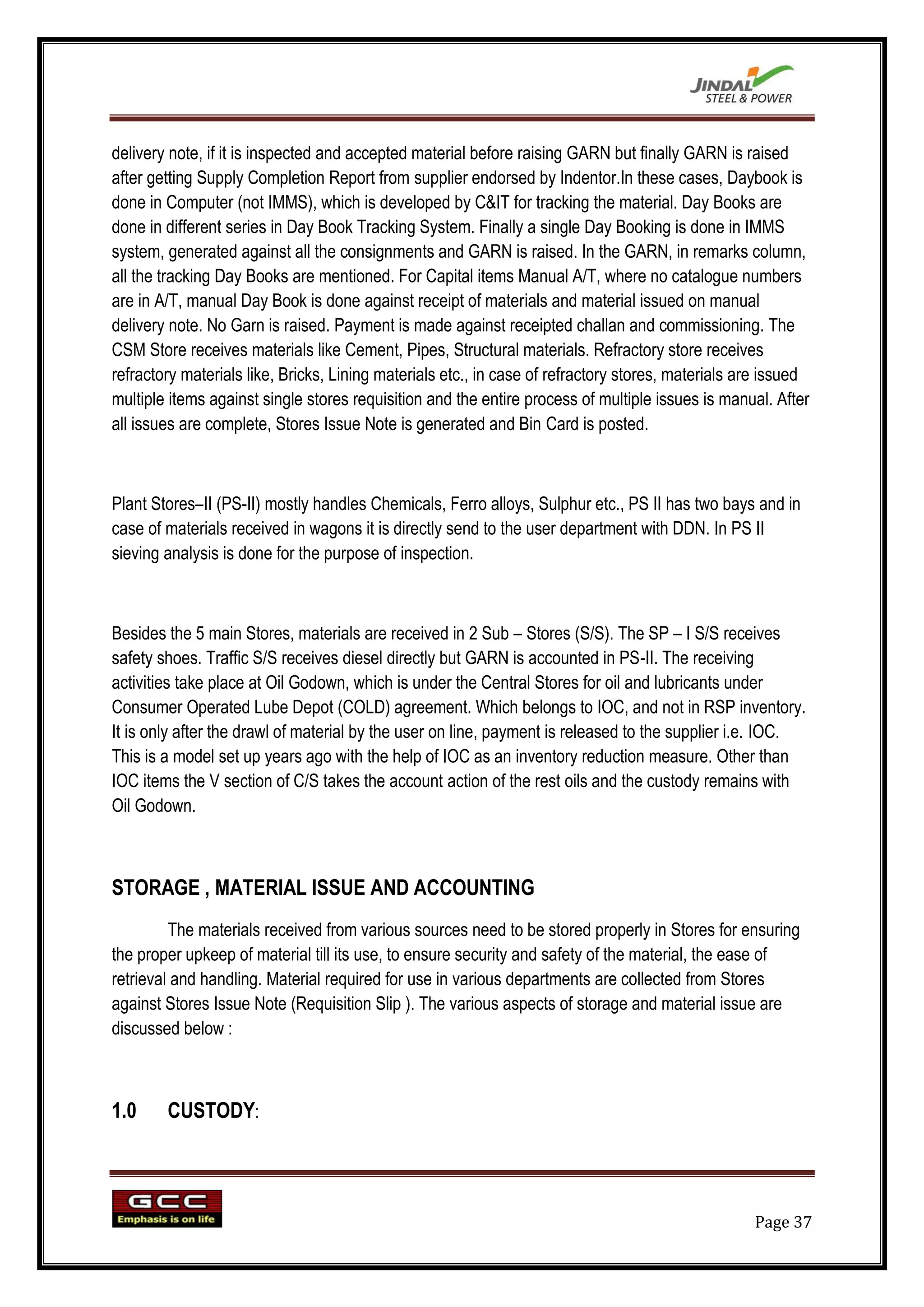

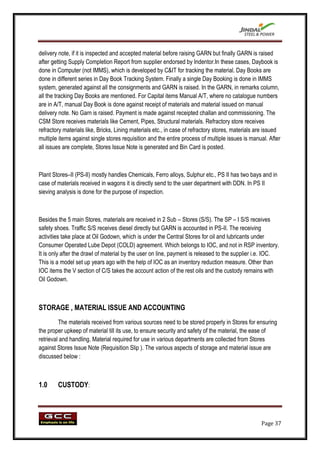

delivery note, if it is inspected and accepted material before raising GARN but finally GARN is raised
after getting Supply Completion Report from supplier endorsed by Indentor.In these cases, Daybook is
done in Computer (not IMMS), which is developed by C&IT for tracking the material. Day Books are
done in different series in Day Book Tracking System. Finally a single Day Booking is done in IMMS
system, generated against all the consignments and GARN is raised. In the GARN, in remarks column,
all the tracking Day Books are mentioned. For Capital items Manual A/T, where no catalogue numbers
are in A/T, manual Day Book is done against receipt of materials and material issued on manual
delivery note. No Garn is raised. Payment is made against receipted challan and commissioning. The
CSM Store receives materials like Cement, Pipes, Structural materials. Refractory store receives
refractory materials like, Bricks, Lining materials etc., in case of refractory stores, materials are issued
multiple items against single stores requisition and the entire process of multiple issues is manual. After
all issues are complete, Stores Issue Note is generated and Bin Card is posted.

Plant Stores–II (PS-II) mostly handles Chemicals, Ferro alloys, Sulphur etc., PS II has two bays and in
case of materials received in wagons it is directly send to the user department with DDN. In PS II
sieving analysis is done for the purpose of inspection.

Besides the 5 main Stores, materials are received in 2 Sub – Stores (S/S). The SP – I S/S receives
safety shoes. Traffic S/S receives diesel directly but GARN is accounted in PS-II. The receiving
activities take place at Oil Godown, which is under the Central Stores for oil and lubricants under
Consumer Operated Lube Depot (COLD) agreement. Which belongs to IOC, and not in RSP inventory.
It is only after the drawl of material by the user on line, payment is released to the supplier i.e. IOC.
This is a model set up years ago with the help of IOC as an inventory reduction measure. Other than
IOC items the V section of C/S takes the account action of the rest oils and the custody remains with
Oil Godown.

STORAGE , MATERIAL ISSUE AND ACCOUNTING
         The materials received from various sources need to be stored properly in Stores for ensuring
the proper upkeep of material till its use, to ensure security and safety of the material, the ease of
retrieval and handling. Material required for use in various departments are collected from Stores
against Stores Issue Note (Requisition Slip ). The various aspects of storage and material issue are
discussed below :

1.0     CUSTODY:

                                                                                                   Page 37
Every custody section of stores has an earmarked area within its bay for receiving all incoming
consignments. Hence, as soon as materials are brought first kept in this place. The custodian in
charge, checks the goods & identify the items with a tag and further follow up action taken for shifting
the materials to its respective locations. While checking the following practices are followed.

a)      Check the description of the supplied material given in the documents with physical number of
goods received as delivery.

b)      Checking should carry on to ensure where damage or breakage is there.

c)       If earlier stock in the Bin Card is there, the materials are to checked and matched with the
existing one.

d)      To possibility the materials are to be stored in the original packing as given by the supplier.

e)      The seals of the reputed firms need not be un-sealed since it runs a risk the contents of the
material, be damaged or deteriorated.

f)      Mention the location on the Bin-Card and all relevant documents.

1.1     POSTING OF GARN:
Custody scrutinizes the GARN as per physical receipt of material, i.e. tally description, quantity, Cat.
No., CTC Code, Unit code, match with existing Stock etc and in case of discrepancy, issue is reverted
to Inspection, Indentor for review/justification and also with physical Bin Card and then posts the
GARN. On posting GARN, it updates Inventory Master & A/T quantity, A/T status. Material can be
drawn / issued only after GARN posting is complete.

1.2     LOCATION:
The location of the stock of each item is maintained in the Bin Card; so that any item can easily be
traced, located for transaction like receipt & issue.

There are two ways of maintaining item locations: Fixed location & Random locations. In the fixed
location system materials are stored in a specific place every time it is received. In Random location

                                                                                                   Page 38
system, items are stored in different locations based on the availability of space and corresponding
location reference is given on the Bin Card against the corresponding stock.

1.3     ISSUE:
The term issue implies the normal supply of materials from Stores to various user departments. Efficient
issue of materials from the Stores is the benchmark to judge the performance of store keeping
functions. Most user departments judge the effectiveness of Stores by the service level of Stores.

The issue of material by Custody is as per requisition, raised on line in Integrated Material Management
System (IMMS) by the user departments. The requisition can be of Capital Items and Revenue Items.

In case of capital items, Finance online clears the Requisition slips. Finance checks ACO code, A/T no.
Also for Cement & structural issued for any project, Finance clears SIN, before issue of Materials.

In case of revenue i.e. centrally procured items & Stock Control items, the requisition is cleared online
by various agencies. After release the Requisition Slip is printed by the respective Indenter /user.
Concerned Department releases quantity for items indented by them (For other Dept‟s stock, clearance
from owner Dept is required), Stock Control for Stock Control items including mechanical and electrical
spares, which were procured earlier by CEC. Safety Dept. for Safety Items, PPC for MRM items, LUHP
for Hydraulic Hoses & Lubes. System checks consumption budget availability before raising requisition.
On availability of budget the requisitions can be printed by Indenter /User and get the hardcopy signed
by an authorized signatory of that department. Each requisition slip is valid for eight days from the date
of generation for physical drawl. More than one requisition can be generated & released even if total
release qty is more than stock availability and the stock is issued on first come first basis on submission
of released requisition slip (hard copy). i.e. generation & release does not assure issue from Stores.

Physical Signature cards at Central Stores are maintained by Administration for Consumables items
and respective bays of Custody for Spares. Blank physical specimens Signature card are issued by
Stores. At other Stores and Sub-Stores Cards are maintained by them and signature verification also is
done by them. C.S. Administration does administrative job related Signature card like issue, change in
name, feeding in system etc. Materials are issued after verification of signature of the person drawing
the item from Stores. At C/S for consumables, Stores Admn person verifies the signature in requisition
slip and for Spares the concerned Bay Store Keeper verifies the specimen signature. Custody cross
checks the signatures in requisition slip and card.

                                                                                                  Page 39
1.4     BIN CARD POSTING:
         Bin Card is the most authenticated record of the custody stores of a particular item as regards
receipts, issue and balance. Hence, it is the mirror of the custodian through which the custodian can
know the location, balance and the history of the material. In all stores of RSP simultaneously physical
bin card as well as on-line system based Bin Card is maintained. On line Bin Card facilitates the
Indentor for quick enquiry of location & balance of the particular item. The Bin Card contains the
complete information of stock number, description, unit, location of the material, source of receipt,
received quantity, issue quantity, document reference, name of the party from whom received or to
whom issued so on.

The requisition slip is sent in duplicate and the Storekeeper checks the requisition slip for
completeness. As per the requisition slip the corresponding bin card to that catalog number is located.
The bin card indicates the location of the material. In IMMS provision has been made to have the
master data of BIN location for one entry only where as in some cases material is kept in more than
one BIN location because of the volume. Material is taken out and issued to department. Requisition
slip is posted and Stores Issue Note (SIN) confirming the issue is generated. This automatically up
dates the Bin card in system. One Copy SIN is handed over to Dept. and the other is retained by
Custody. Physical Bin cards are up dated IMMS Bin Card updates on issue of SIN. The copy of SIN is
deposited at gate for taking out the material from Stores Gate.

1.5     STOCK TRANSFER VOUCHER:
In case of transfer of material from Main Stores to Sub stores, a requisition is received from sub-
stores, which is called Stock Transfer Voucher (STV requisition slip). STV is printed from IMMS on pre-
printed stationery, which has color-coded copies for easy identification, is prepared in IMMS and the
printed document is brought to stores against Requisition Slip received from Dept. For Stock Control
and centrally procured items, STV is cleared on line by different agencies and material is given based
on the printout with signature. In such cases, total quantity of inventory does not change since this is
considered as a change in location. The location code in IMMS is changed. Inventory status changes
as soon as Requisition Slip is posted. STV is posted in Bin Card manually and data base is updated
automatically.

1.6     BOOK TRANSFER VOUCHER:

                                                                                                 Page 40

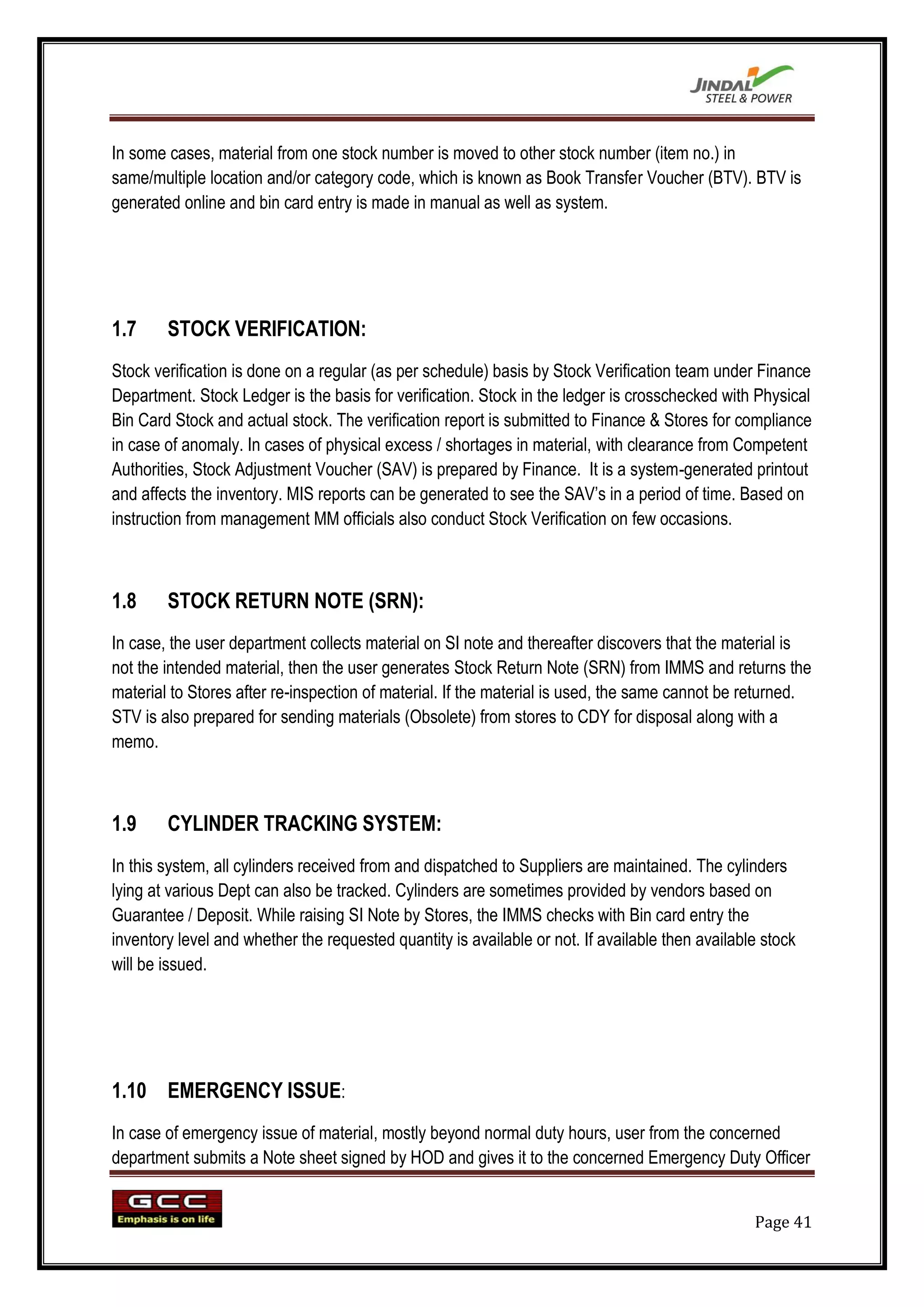

In some cases, material from one stock number is moved to other stock number (item no.) in
same/multiple location and/or category code, which is known as Book Transfer Voucher (BTV). BTV is
generated online and bin card entry is made in manual as well as system.

1.7     STOCK VERIFICATION:
Stock verification is done on a regular (as per schedule) basis by Stock Verification team under Finance
Department. Stock Ledger is the basis for verification. Stock in the ledger is crosschecked with Physical
Bin Card Stock and actual stock. The verification report is submitted to Finance & Stores for compliance
in case of anomaly. In cases of physical excess / shortages in material, with clearance from Competent
Authorities, Stock Adjustment Voucher (SAV) is prepared by Finance. It is a system-generated printout
and affects the inventory. MIS reports can be generated to see the SAV‟s in a period of time. Based on
instruction from management MM officials also conduct Stock Verification on few occasions.

1.8     STOCK RETURN NOTE (SRN):
In case, the user department collects material on SI note and thereafter discovers that the material is
not the intended material, then the user generates Stock Return Note (SRN) from IMMS and returns the
material to Stores after re-inspection of material. If the material is used, the same cannot be returned.
STV is also prepared for sending materials (Obsolete) from stores to CDY for disposal along with a
memo.

1.9     CYLINDER TRACKING SYSTEM:
In this system, all cylinders received from and dispatched to Suppliers are maintained. The cylinders
lying at various Dept can also be tracked. Cylinders are sometimes provided by vendors based on
Guarantee / Deposit. While raising SI Note by Stores, the IMMS checks with Bin card entry the
inventory level and whether the requested quantity is available or not. If available then available stock
will be issued.

1.10 EMERGENCY ISSUE:
In case of emergency issue of material, mostly beyond normal duty hours, user from the concerned
department submits a Note sheet signed by HOD and gives it to the concerned Emergency Duty Officer

                                                                                                  Page 41
(EDO) in Stores. After checking the note sheet, Stores gives a written memo to CISF and concerned
Store Keeper. Concerned Stores/Bay is opened in presence of CISF and material issued. Transaction
is regularized later through requisition slip and Note-Sheet.

1.11 MISCELLAUNOUS;
Material is issued to suppliers for Recondition items/Conversion items. (Under Inventory Category for
sending the material and thereafter is received back under IC for receipt of re-conditioned material.

Material is issued on loan to sister steel plants. Against dispatch note, excise clearance etc. This is
done in case of urgency.

1.12. PRESERVATION;
There is a time tag between the receipt & actual use of the material. Different materials get deteriorated
to different extent during the storage period based on the nature of the items. So the items need to be
preserved to maintained their useful life. Items need to be initially preserved to avoid deterioration
during the storage and subsequently they need to be verified for any change in their conditions and
corrective action need to be taken to restore the preservation.

         The materials which are rusted due to long storage in the open Yard are attended for
preservation by the section of the custodians of stores. Before every monsoon, the materials are re-
painted and stock numbers and other descriptions are again written by paint on the body of the
material. In Central Store there is a provision for preservation i.e. a specific format on which concerned
store keeper (s) of custody, reports the custody officer about the materials ( Bearings or Spares ) which
are getting rusted or supposed to be unusable due to long storage. The custody officer make necessary
arrangements i.e. cleaning or greasing of the components accordingly. In other stores the concerned
store keepers look after this matter.

       Besides this a A/C store is there under Central Stores where rubber items such as
Diaphragms, some kinds of V-Belts, PVC tapes, certain chemicals and adhesives, electronic
components and computer spare etc., are stored for proper preservation.

2.0     SUB-STORES:

                                                                                                   Page 42
The materials used by multiple users are usually stored at Central Stores from where all the users get
the material. Where as the material which in particular user department only can be stored in a store
nearer to that department itself. Such stores are Sub-Stores in which all shop specific items and some
regularly used central items are stored.

Most of the major Departments get services through Sub- Stores for important and repetitive items both
Consumables and Spares. Departments getting a Sub-Store facility, give Requisition Slip to Sub-Stores
for Spares and for Consumables the request of requirement is made through entry in the Register kept
at all Sub-Stores. In turn Sub-Stores raises STV‟s against the Requisition Slips for the collection of the
material required by the department and contact the PCC for the transportation of the material. Sub-
Stores representative accompanies the vehicle earmarked for a Sub-stores and collects the material
from Main Stores through STV ( for stores transfer to sub stores ).

        Though the main functions of sub-Stores are to collect consumables and spares from main
stores and issue these materials to the user departments to whom the S/S are attached to, but 2 out of
the 5 S/S also performs receiving function also (as mentioned earlier). SP –I S/S receives safety shoes
and issue the same to various departments of plant against requisition slips.

        Besides performing the S/S function, Traffic S/S receives Diesel. Diesel is supplied to RSP by
Indian Oil Corporation (IOC),by the MoU between SAIL and IOC. Diesel comes in to the plant by road
tankers from IOC‟s Tata Nagar Depot and unloaded at Traffic S/S. Again the same is issued to
Locomotives of Traffic and Raw Material (T&RM) Department, and other production units against SI
Notes (Requisition Slips). T&RM is the main consumer of Diesel. At Traffic S/S the receipt and issue of
Diesel are done by following the “Diesel receipt and issue Procedure”, and GARN is accounted at PS –
II.

         When the road tanker reports at Traffic S/S, the concerned storekeeper checks the challan,
way bill, gate entry no. and the seal of the tanker and note these particulars in the Diesel Receipt
Register. If found OK then the tanker is permitted to take inside of the unloading premises, where the
seal of the tanker is opened and the Dip (quantity in cm) and density of the tanker is measured. If there
is any shortage the same is mentioned in the challan and the signature of the driver is obtained on the
challan. Diesel is stored in 4 Vertical tanks ( T.No. 1 &2 having the capacity of 113650 liters each & T
No. 5 & 6 – 142000 liters, each having the total of 513000 liters.

                                                                                                 Page 43

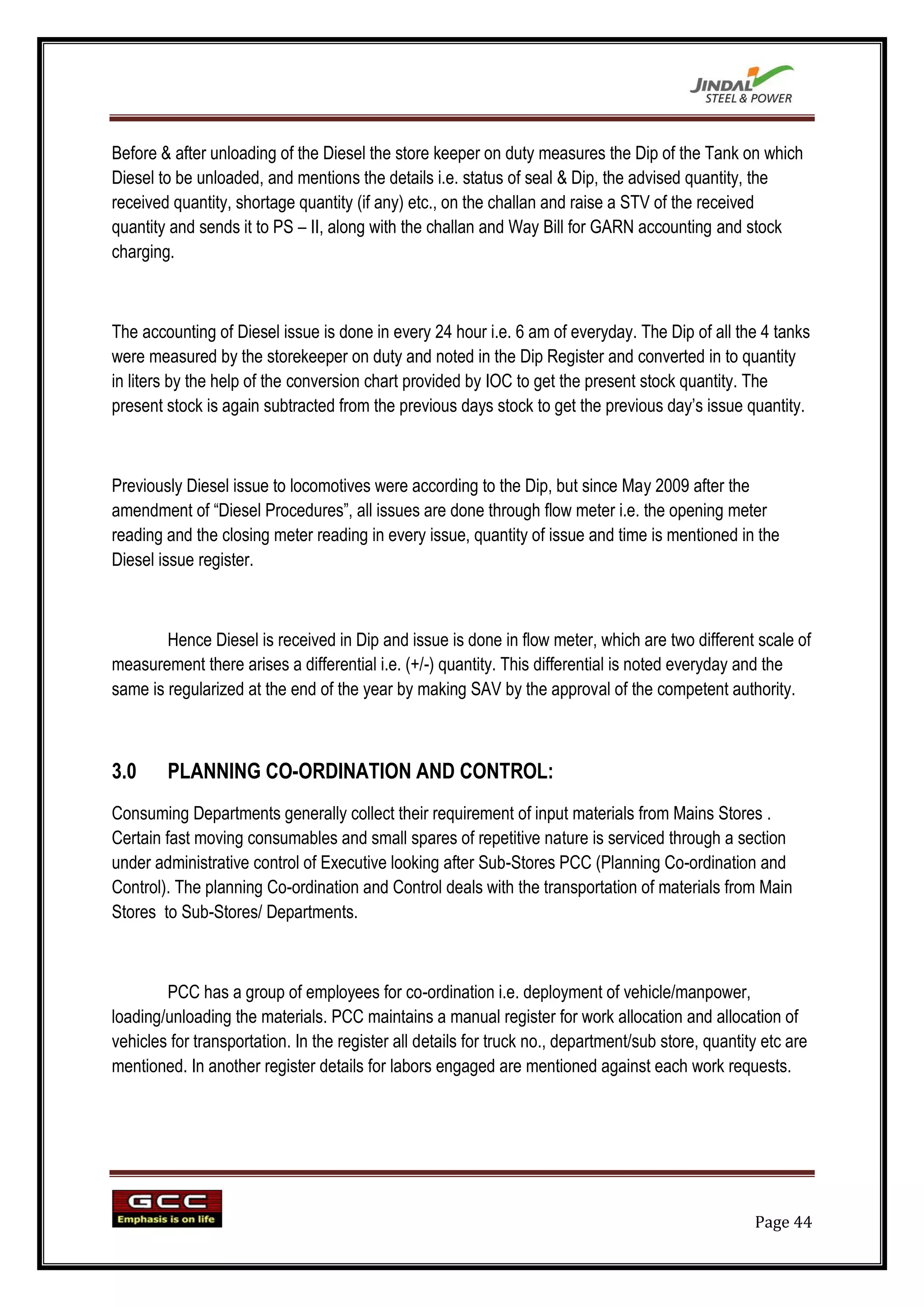

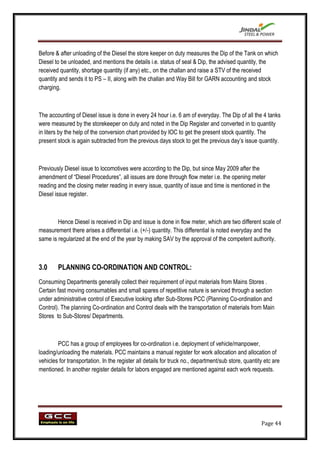

Before & after unloading of the Diesel the store keeper on duty measures the Dip of the Tank on which
Diesel to be unloaded, and mentions the details i.e. status of seal & Dip, the advised quantity, the
received quantity, shortage quantity (if any) etc., on the challan and raise a STV of the received
quantity and sends it to PS – II, along with the challan and Way Bill for GARN accounting and stock
charging.

The accounting of Diesel issue is done in every 24 hour i.e. 6 am of everyday. The Dip of all the 4 tanks
were measured by the storekeeper on duty and noted in the Dip Register and converted in to quantity
in liters by the help of the conversion chart provided by IOC to get the present stock quantity. The
present stock is again subtracted from the previous days stock to get the previous day‟s issue quantity.

Previously Diesel issue to locomotives were according to the Dip, but since May 2009 after the
amendment of “Diesel Procedures”, all issues are done through flow meter i.e. the opening meter
reading and the closing meter reading in every issue, quantity of issue and time is mentioned in the
Diesel issue register.

        Hence Diesel is received in Dip and issue is done in flow meter, which are two different scale of
measurement there arises a differential i.e. (+/-) quantity. This differential is noted everyday and the
same is regularized at the end of the year by making SAV by the approval of the competent authority.

3.0     PLANNING CO-ORDINATION AND CONTROL:
Consuming Departments generally collect their requirement of input materials from Mains Stores .
Certain fast moving consumables and small spares of repetitive nature is serviced through a section
under administrative control of Executive looking after Sub-Stores PCC (Planning Co-ordination and
Control). The planning Co-ordination and Control deals with the transportation of materials from Main
Stores to Sub-Stores/ Departments.

        PCC has a group of employees for co-ordination i.e. deployment of vehicle/manpower,
loading/unloading the materials. PCC maintains a manual register for work allocation and allocation of
vehicles for transportation. In the register all details for truck no., department/sub store, quantity etc are
mentioned. In another register details for labors engaged are mentioned against each work requests.

                                                                                                     Page 44

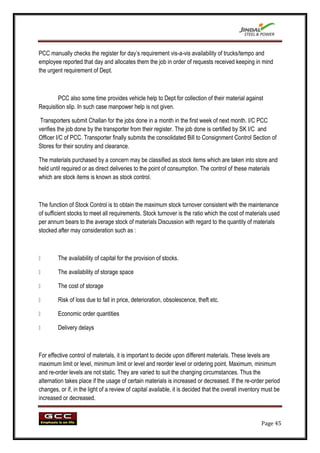

PCC manually checks the register for day‟s requirement vis-a-vis availability of trucks/tempo and
employee reported that day and allocates them the job in order of requests received keeping in mind
the urgent requirement of Dept.

        PCC also some time provides vehicle help to Dept for collection of their material against
Requisition slip. In such case manpower help is not given.

 Transporters submit Challan for the jobs done in a month in the first week of next month. I/C PCC
verifies the job done by the transporter from their register. The job done is certified by SK I/C and
Officer I/C of PCC. Transporter finally submits the consolidated Bill to Consignment Control Section of
Stores for their scrutiny and clearance.

The materials purchased by a concern may be classified as stock items which are taken into store and
held until required or as direct deliveries to the point of consumption. The control of these materials
which are stock items is known as stock control.

The function of Stock Control is to obtain the maximum stock turnover consistent with the maintenance
of sufficient stocks to meet all requirements. Stock turnover is the ratio which the cost of materials used
per annum bears to the average stock of materials Discussion with regard to the quantity of materials
stocked after may consideration such as :

       The availability of capital for the provision of stocks.

       The availability of storage space

       The cost of storage

       Risk of loss due to fall in price, deterioration, obsolescence, theft etc.

       Economic order quantities

       Delivery delays

For effective control of materials, it is important to decide upon different materials. These levels are
maximum limit or level, minimum limit or level and reorder level or ordering point. Maximum, minimum
and re-order levels are not static. They are varied to suit the changing circumstances. Thus the
alternation takes place if the usage of certain materials is increased or decreased. If the re-order period
changes, or if, in the light of a review of capital available, it is decided that the overall inventory must be
increased or decreased.

                                                                                                      Page 45
Principal functions of Stock Control are :

a) Indenting for AP items – Normal and Capital Repair Requirements. Rate Contract Indent requisition
with Price Variation Clause is also initiated by Stock Control.

b) Monitoring of materials based on requisition and managing release as per priority and consumption.

c) Follow-up of Supplies as per safety stock requirements thru Purchase Inspection etc.

d) Technical Scrutiny / Co-Ordinate technical scrutiny for AP items with concerned User Dept /
Centralized agencies.

e) Raise on line requisition for updating Specs for AP Items through SRG Inventory Management for
ABC, XYZ analysis, Non Moving (5 Years), Deemed Non Moving(4 years), Potential Non Moving ( 3
years), Deemed Obsolete, Obsolete, Deemed Surplus, Surplus declaration along with all approvals, as
per RSP / SAIL guideline g) MIS of Stores is co-ordinated by and maintained at Stock Control.

f) Task Force activities as Convenor for several TF items.

 g) Stock Control is member of CPA items where RSP is CPA and also where other Plants are CPA.
CPA requirements are sent to CPA Plant after clearance of ) Stock Control also represents MM during
review meetings held in the Office of ED(W).

h) Stock Control co-ordinates & raises SDA for materials to be sent to other Steel Plant to meet their
urgent requirements.

i) SC clears the Non stock Consumable indents as screening committee member on line.

j) SC co-ordinates for Inventory control of stores & spares.

ADDITIONAL FUNCTIONS :
1. SC is also convener of Task Force items (10 TF groups), such as Minor raw materials, conveyor
belts etc where both AP and non-AP items are involved. Separate Screen for entry of Requirements etc
for Task Force.

2. Stock Control is the Nodal, Convenor & Member for Indents of Consumable items.

3.      Stock control focuses on maintaining Optimum Inventory for stock items, Non-stock
consumable items & Task Force items , where S/C is the Convenor. Stock control focuses on “ No
stock out situation” for Stock items.

  4.    Various review period policies like 6/12/18 months are maintained depending upon the lead
time and rate of consumption. Stocks are reviewed periodically as per above policies and indents are
raised as and when required. SC updates Re-order level, Max. level of items, Safety stock level for

                                                                                                 Page 46

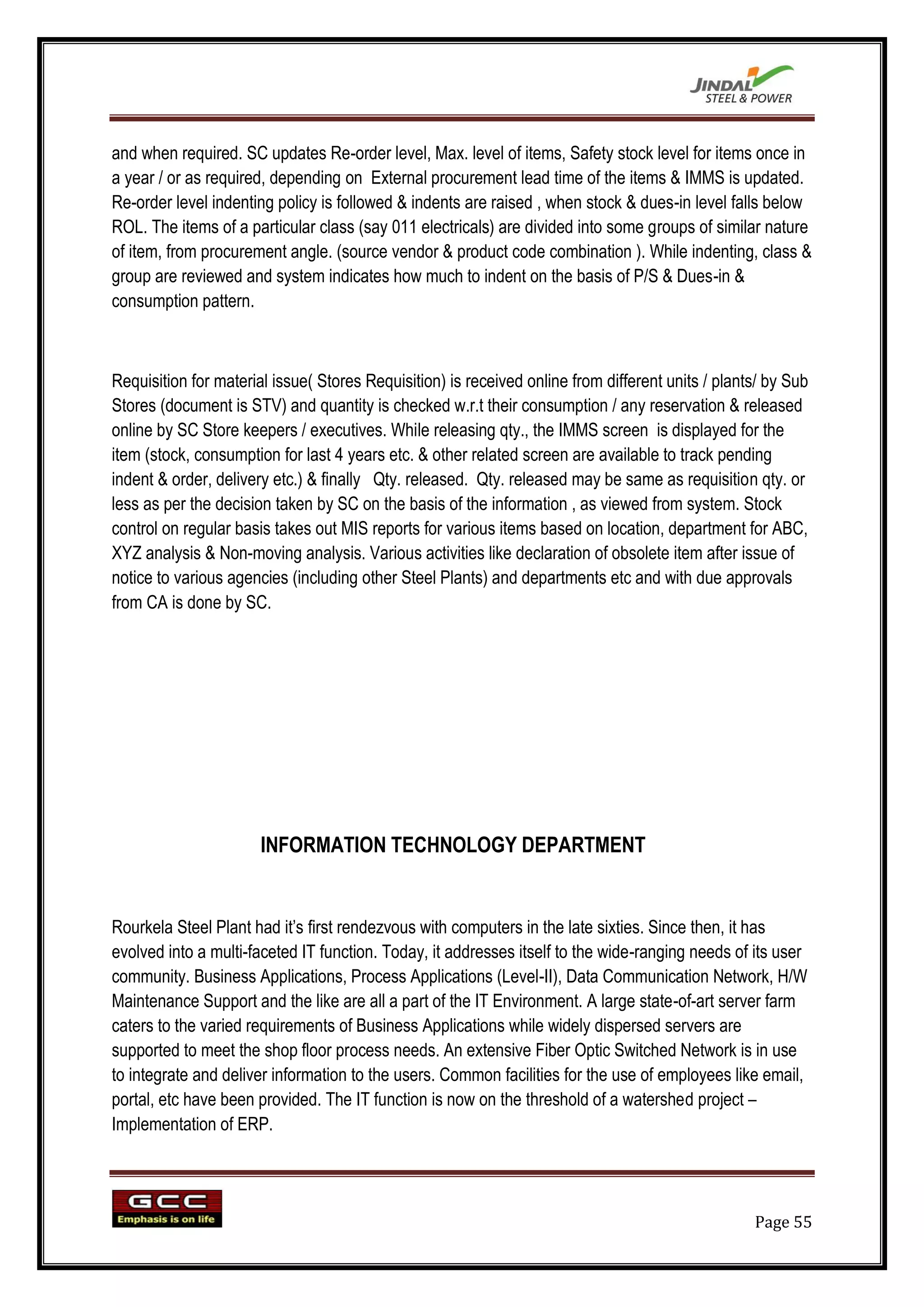

items once in a year / or as required, depending on External procurement lead time of the items &
IMMS is updated. Re-order level-indenting policy is followed & indents are raised, when stock & dues-in
level falls below ROL. The items of a particular class (say 011 electricals) are divided into some groups
of similar nature of item, from procurement angle. (Source vendor & product code combination ). While
indenting, class & group are reviewed and system indicates how much to indent on the basis of P/S &
Dues-in & consumption pattern.

5.       Requisition for material issue (Stores Requisition) is received online from different units /
plants/ by Sub Stores (document is STV) and quantity is checked w.r.t their consumption / any
reservation & released online by SC Store keepers / executives. While releasing qty., the IMMS screen
is displayed for the item (stock, consumption for last 4 years etc. & other related screen are available to
track pending indent & order, delivery etc.) & finally Qty. released. Qty. released may be same as
requisition qty. or less as per the decision taken by SC on the basis of the information, as viewed from
system. Stock control on regular basis takes out MIS reports for various items based on location,
department for ABC, XYZ analysis & Non-moving analysis. Various activities like declaration of
obsolete item after issue of notice to various agencies (including other Steel Plants) and departments
etc and with due approvals from CA is done by SC.

6.     SC is also convener of Task Force items (10 TF groups), such as Minor raw materials,
conveyor belts etc where both AP and non-AP items are involved. Separate Screen for entry of
Requirements etc for Task Force.

INVENTORY MANAGEMENT & POLICY GUIDE LINES FOR STORE KEEPING

1.0     INVENTORY MANAGEMENT

      For effective Inventory Management, control is exercised on all activities of Materials
Management like placement of order, receipt, storage & issues.

RAISING INDENT :

                Indents for procurement of stores and spares raised by the authorized executive of
department subject to availability of budget with the approval of competent authority of the
department/office. The indents are raised in prescribed format . Past performance of vendors, who

                                                                                                  Page 47
have supplied same or similar items, should be indicated in the format while raising the indent. In case
there is any deviation/complaint with reference to the quality parameters, it may be clearly specified in
the indent.

ORDER PLACEMENT :

Wherever feasible, staggered deliveries must be resorted to, keeping in view the requirements of
production units, to have proper control on Inventory.

For items having limited shelf life, the delivery schedule (time as well as quantity) should take care of
shelf life. (At least 80% of the shelf-life will be mandatory at the time of receipt stage).

For class „A‟ & „X‟ items, the quantity to be ordered is to be reviewed again before placement of order,
keeping in mind the future production plan, repair / replacement plan, stock at stores / shop floor,
pending indents, dues in etc.

For orders having overdue delivery, confirmation from head of user department may be obtained before
giving clearance for delivery.

Simplified Procedure to be formulated by CMMG and implemented for procurement of „Low Value
Items‟ (for indent value up to Rs.25,000/- ) in order to avoid „Stock-Out‟ and improve „Service Level‟.

Cancellation of pending Orders. In case a supplier, to whom an order has been placed, failed to
supply, appropriate action may be taken as indicated in clause 18 of PP2K. Where deliveries have
overshot the stipulated due date of the A/T and material has not been received, such orders will be
reviewed on regular basis and if required, orders pending for 2 years and more would be cancelled
after:

a) Obtaining a certificate from the indenter that these materials will not be required at least for coming
two years.

b) Ensuring that these materials are not required to be returned, if borrowed.

c) Ensuring that there are no requirement pending with Purchase Department for such materials.

d) Ensuring that no advance payment is pending with the supplier.

                                                                                                   Page 48

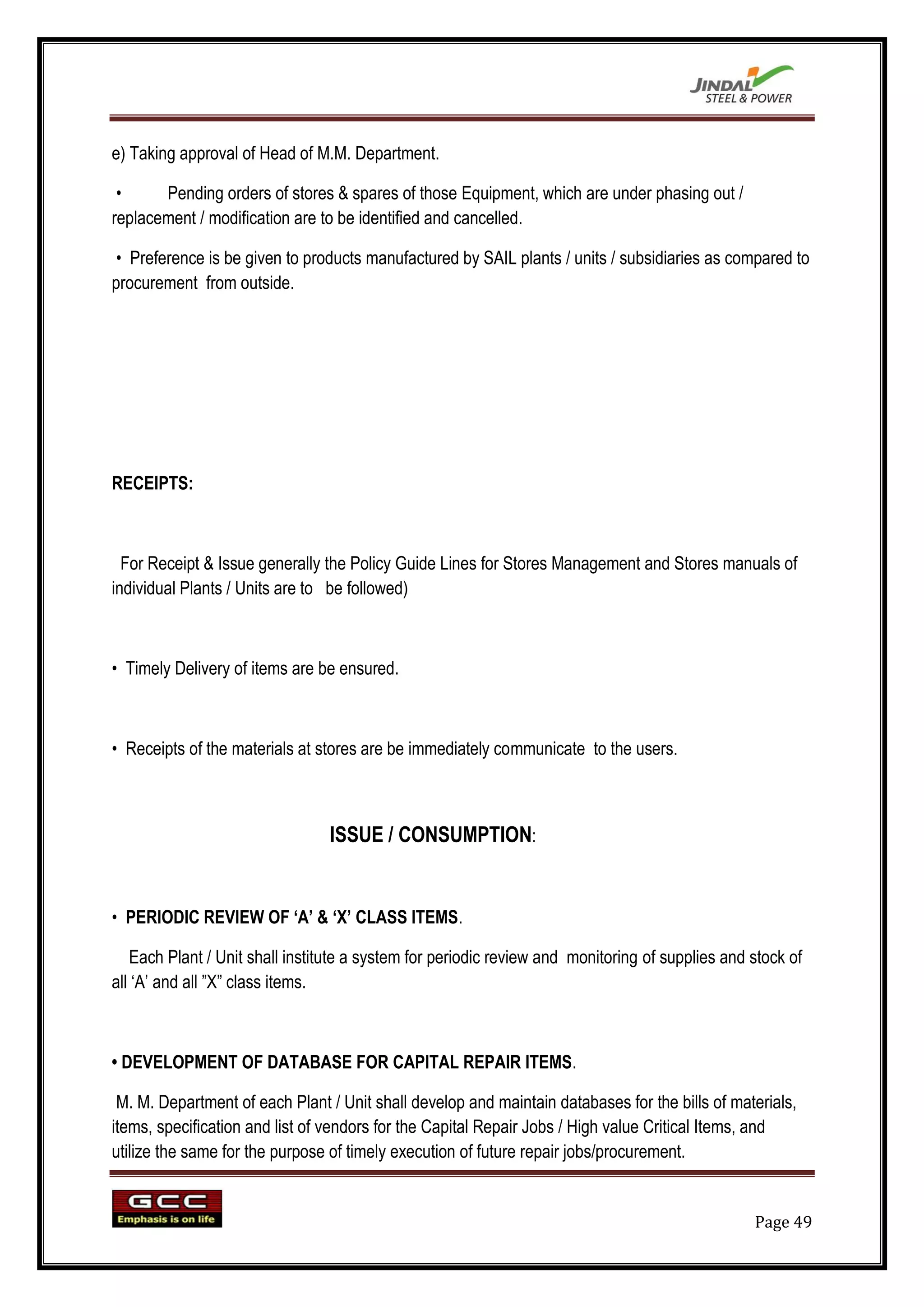

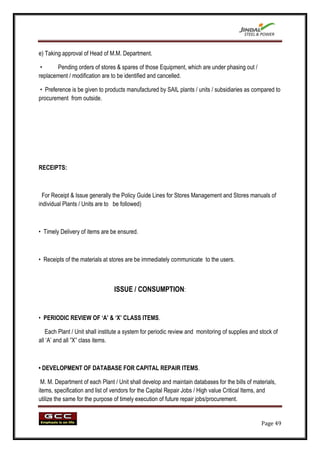

e) Taking approval of Head of M.M. Department.

 •     Pending orders of stores & spares of those Equipment, which are under phasing out /
replacement / modification are to be identified and cancelled.

 • Preference is be given to products manufactured by SAIL plants / units / subsidiaries as compared to
procurement from outside.

RECEIPTS:

  For Receipt & Issue generally the Policy Guide Lines for Stores Management and Stores manuals of
individual Plants / Units are to be followed)

• Timely Delivery of items are be ensured.

• Receipts of the materials at stores are be immediately communicate to the users.

                                 ISSUE / CONSUMPTION:

• PERIODIC REVIEW OF „A‟ & „X‟ CLASS ITEMS.

   Each Plant / Unit shall institute a system for periodic review and monitoring of supplies and stock of
all „A‟ and all ”X” class items.

• DEVELOPMENT OF DATABASE FOR CAPITAL REPAIR ITEMS.

 M. M. Department of each Plant / Unit shall develop and maintain databases for the bills of materials,
items, specification and list of vendors for the Capital Repair Jobs / High value Critical Items, and
utilize the same for the purpose of timely execution of future repair jobs/procurement.

                                                                                                 Page 49
• CONTINUOUS AND CLOSE INTERACTION BETWEEN M.M. DEPARTMENT AND INDENTERS.

  M.M. Department of each Plant Unit shall develop a system of keeping the indenters informed on
regular basis about the status of indent, delivery, receipt and stock at stores.

• Indenters shall be intimated if the materials are not drawn within three months of receipt. Drawl plan
may be asked for and reviewed periodically.

FAST MOVING AND SLOW MOVING ITEMS.

• Fast moving inventory is monitored closely in order to avoid stock out as well to control consumption.

• Slow moving / deemed non-moving items is reviewed periodically or otherwise the same may lead to
“non-moving”.

• Pending orders / Indents of slow moving items is reviewed annually in consultation with the indenting.

2.0 ABC & XYZ ANALYSIS FOR INVENTORY MANAGEMENT:

Stores & Spares items as reported at the beginning of the financial year, in the stock ledger, shall be
considered for analysis and for arriving at „ABC‟ & „XYZ‟ Categorization. Items like shop floor inventory,
store-in-transit, provisions and minor raw materials will be excluded while categorizing the items as
„ABC‟ & „XYZ‟.

• ABC Categorization:

        Items which constitute top 70% ( seventy percent) of total consumption ( of stores & spares)
value, when arrange in descending order of consumption value will be termed as „A‟ class items. (
Consumption values will be based on that of previous financial year) Next 20% ( twenty percent) will be
termed as „B‟ class and the rest as „C‟ class items.

• XYZ Categorization:

                                                                                                  Page 50

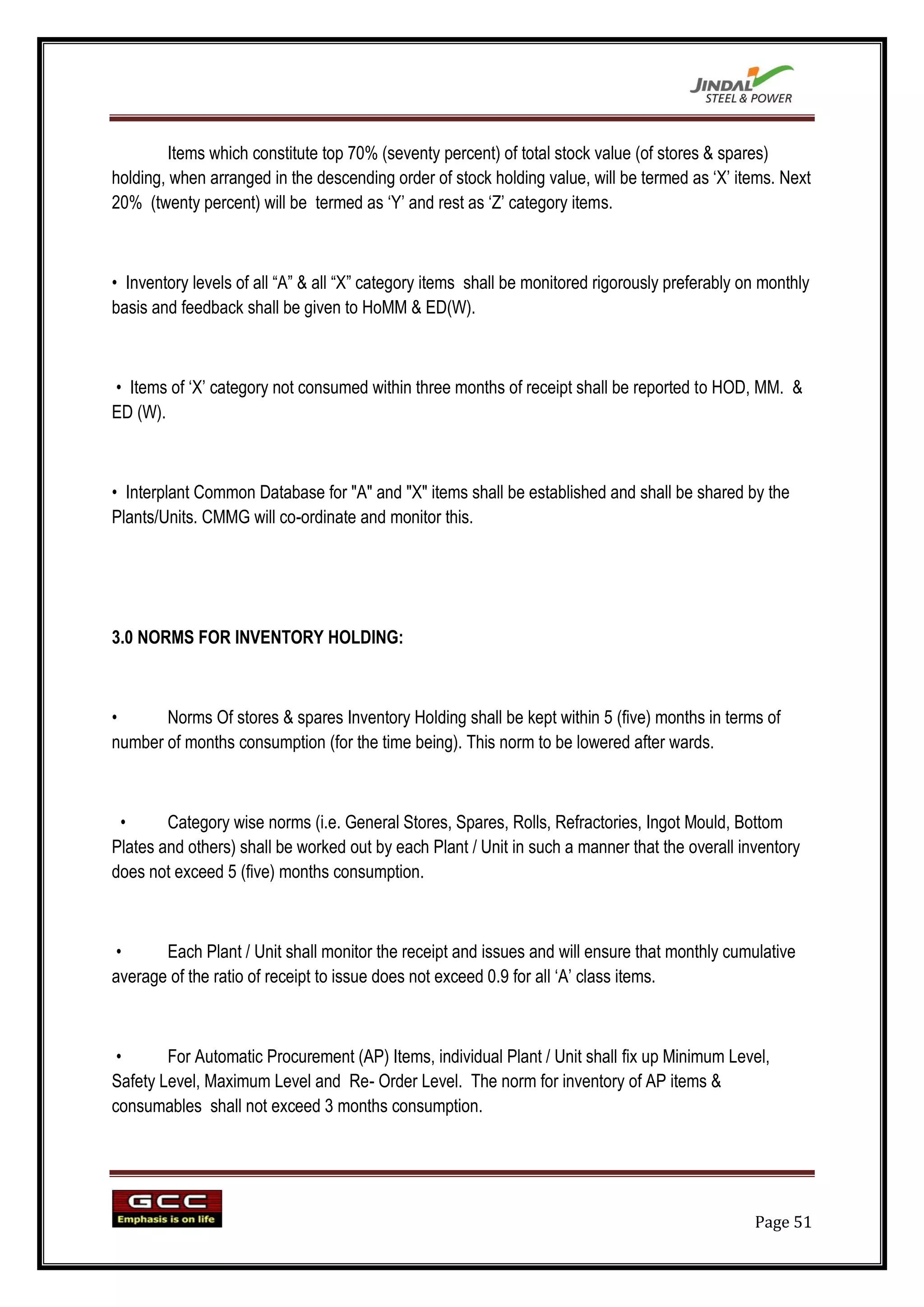

Items which constitute top 70% (seventy percent) of total stock value (of stores & spares)
holding, when arranged in the descending order of stock holding value, will be termed as „X‟ items. Next
20% (twenty percent) will be termed as „Y‟ and rest as „Z‟ category items.

• Inventory levels of all “A” & all “X” category items shall be monitored rigorously preferably on monthly
basis and feedback shall be given to HoMM & ED(W).

• Items of „X‟ category not consumed within three months of receipt shall be reported to HOD, MM. &
ED (W).

• Interplant Common Database for "A" and "X" items shall be established and shall be shared by the
Plants/Units. CMMG will co-ordinate and monitor this.

3.0 NORMS FOR INVENTORY HOLDING:

•      Norms Of stores & spares Inventory Holding shall be kept within 5 (five) months in terms of
number of months consumption (for the time being). This norm to be lowered after wards.

 •      Category wise norms (i.e. General Stores, Spares, Rolls, Refractories, Ingot Mould, Bottom
Plates and others) shall be worked out by each Plant / Unit in such a manner that the overall inventory
does not exceed 5 (five) months consumption.

 •     Each Plant / Unit shall monitor the receipt and issues and will ensure that monthly cumulative
average of the ratio of receipt to issue does not exceed 0.9 for all „A‟ class items.

 •      For Automatic Procurement (AP) Items, individual Plant / Unit shall fix up Minimum Level,
Safety Level, Maximum Level and Re- Order Level. The norm for inventory of AP items &
consumables shall not exceed 3 months consumption.

                                                                                                 Page 51
RECONDITIONING OF SPARES & EQUIPMENT:

Each plant shall fix the targets for identifying spares & equipment, which can be reconditioned
instead of fresh procurement. Separate allocation of funds may be made for the reconditioning activity.
A centralized cell / agency in each plant under Head of Maintaince. shall be responsible for this
activity. Plant to have a time based maintenance system for replacement and reconditioning of high
value spares. Item flow to be traced through the computerized MM system with suitable stores
valuation / pricing for the same.

    INSURANCE INVENTORY:

a) DEFINITION OF INSURANCE INVENTORY.

An Item shall be considered as an Insurance Inventory

• Failure of which will result in stoppage of production process not only of the concerned shop but will
also affect the preceding & succeeding shops.

• Which normally does not fail but whose life expectancy is uncertain.

• Which is generally a tailor made item. If it is standard item, then not readily available.

• Which is identified / recommended by the Original Equipment Manufacturer (OEM) as Insurance item
at the time of procurement. Insurance spares shall be declared at time of procurement of Original
equipment. User department while recommending an item as Insurance, shall ensure the fulfillment of
any / all the above criteria. `Declaration of insurance spares shall be done with the approval of
Executive Director, (Works).Worthiness or physical condition of the insurance items may be examined
every year by each user. Insurance items in store may be installed in the plant within 5 to 10 years by
the user and the old one may be repaired / re-conditioned and kept in stores for future use.

•     PAYMENT MODULE (FINANCE)

Interconnection of material management system with other available computer system should be done
within the financial year 2003-04.

                                                                                                 Page 52
5.0. COMPUTERISATION OF MM ACTIVITIES:

The computerised system of processing the entire activities chain of Material Management and the
related functions including management of documents/forms involved, are known as IMMS (Integrated
Material Management System ) It generally covers the following functions

 •   CATALOGUING

•     MATERIAL REQUIREMENT PLANNING

•     BUDGETING

•     INDENTING

•     INDENT SCREENING

•     PURCHASE

•     STORES MODULE

•     DISPOSAL

•     VENDOR RATING MODULE

•     PAYMENT MODULE (FINANCE)

 Inter-connection of material management system with other available computer system should be done
within the financial year 2003-04.For providing company wide integrated information on an on-line basis
to enable timely and more accurate decisions, the ERP (Enterprise Resource Planning )is under
implementation at all plants. The MM/SRM ( supplier relationship module ), SCM (supply chain module
) are part of the total ERP.

6.0. SYSTEMS & PROCEDURES:

Each plant should review existing systems & procedures and simplify the same keeping it in
conformity with PP2K so that nil value addition/wasteful/unnecessary activities are eliminated”. This
will result in reduction in costs. Illustrated area for improvements are

Simplified Procedure for procurement of low value items.

                                                                                               Page 53

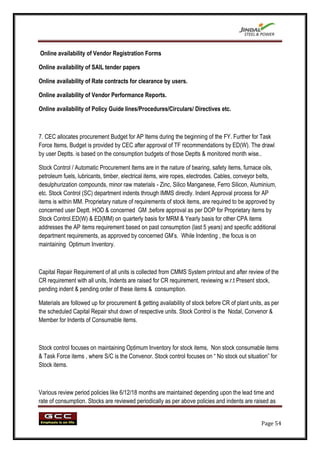

Online availability of Vendor Registration Forms

Online availability of SAIL tender papers

Online availability of Rate contracts for clearance by users.

Online availability of Vendor Performance Reports.

Online availability of Policy Guide lines/Procedures/Circulars/ Directives etc.

7. CEC allocates procurement Budget for AP Items during the beginning of the FY. Further for Task
Force Items, Budget is provided by CEC after approval of TF recommendations by ED(W). The drawl
by user Deptts. is based on the consumption budgets of those Deptts & monitored month wise..

Stock Control / Automatic Procurement Items are in the nature of bearing, safety items, furnace oils,
petroleum fuels, lubricants, timber, electrical items, wire ropes, electrodes. Cables, conveyor belts,
desulphurization compounds, minor raw materials - Zinc, Silico Manganese, Ferro Silicon, Aluminium,
etc. Stock Control (SC) department indents through IMMS directly. Indent Approval process for AP
items is within MM. Proprietary nature of requirements of stock items, are required to be approved by
concerned user Deptt. HOD & concerned GM ,before approval as per DOP for Proprietary items by
Stock Control.ED(W) & ED(MM) on quarterly basis for MRM & Yearly basis for other CPA items
addresses the AP items requirement based on past consumption (last 5 years) and specific additional
department requirements, as approved by concerned GM‟s. While Indenting , the focus is on
maintaining Optimum Inventory.

Capital Repair Requirement of all units is collected from CMMS System printout and after review of the
CR requirement with all units, Indents are raised for CR requirement, reviewing w.r.t Present stock,
pending indent & pending order of these items & consumption.

Materials are followed up for procurement & getting availability of stock before CR of plant units, as per
the scheduled Capital Repair shut down of respective units. Stock Control is the Nodal, Convenor &
Member for Indents of Consumable items.

Stock control focuses on maintaining Optimum Inventory for stock items, Non stock consumable items
& Task Force items , where S/C is the Convenor. Stock control focuses on “ No stock out situation” for
Stock items.

Various review period policies like 6/12/18 months are maintained depending upon the lead time and
rate of consumption. Stocks are reviewed periodically as per above policies and indents are raised as

                                                                                                  Page 54

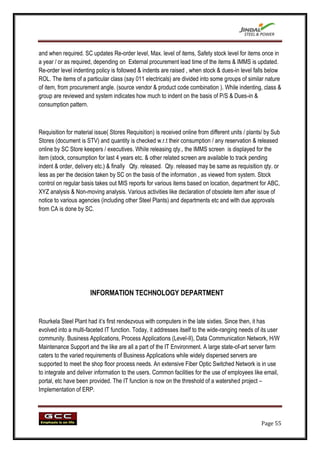

and when required. SC updates Re-order level, Max. level of items, Safety stock level for items once in
a year / or as required, depending on External procurement lead time of the items & IMMS is updated.
Re-order level indenting policy is followed & indents are raised , when stock & dues-in level falls below
ROL. The items of a particular class (say 011 electricals) are divided into some groups of similar nature
of item, from procurement angle. (source vendor & product code combination ). While indenting, class &
group are reviewed and system indicates how much to indent on the basis of P/S & Dues-in &
consumption pattern.

Requisition for material issue( Stores Requisition) is received online from different units / plants/ by Sub
Stores (document is STV) and quantity is checked w.r.t their consumption / any reservation & released
online by SC Store keepers / executives. While releasing qty., the IMMS screen is displayed for the
item (stock, consumption for last 4 years etc. & other related screen are available to track pending
indent & order, delivery etc.) & finally Qty. released. Qty. released may be same as requisition qty. or
less as per the decision taken by SC on the basis of the information , as viewed from system. Stock
control on regular basis takes out MIS reports for various items based on location, department for ABC,
XYZ analysis & Non-moving analysis. Various activities like declaration of obsolete item after issue of
notice to various agencies (including other Steel Plants) and departments etc and with due approvals
from CA is done by SC.

                       INFORMATION TECHNOLOGY DEPARTMENT

Rourkela Steel Plant had it‟s first rendezvous with computers in the late sixties. Since then, it has
evolved into a multi-faceted IT function. Today, it addresses itself to the wide-ranging needs of its user
community. Business Applications, Process Applications (Level-II), Data Communication Network, H/W
Maintenance Support and the like are all a part of the IT Environment. A large state-of-art server farm
caters to the varied requirements of Business Applications while widely dispersed servers are
supported to meet the shop floor process needs. An extensive Fiber Optic Switched Network is in use
to integrate and deliver information to the users. Common facilities for the use of employees like email,
portal, etc have been provided. The IT function is now on the threshold of a watershed project –
Implementation of ERP.

                                                                                                   Page 55
COMPUTING RESOURCES

•      SUN SS20 / 712

•      SUN ENTERPRISE 3000

•      SUN HYPER SPARC

•      SUN BLADE 2000

•      SUN FIRE 280R (2 Nos.)

•      SUN FIRE 480R (2 Nos.)

•      SUN 3510 FIBER STORAGE

•      SUN ENTERPRISE 3000

•      SUN FIRE V440 (2 Nos.)

•      IBM x-236 XEON SERVER (5 Nos.)

•      CISCO PIX 535E FIREWALL

•      CISCO 4210 IPS

•      WINDOWS 2000 SERVER for e - Procurement Data Exchange

                                  JSPL NETWORK

  The life line of JPL Computerisation is the 100Mbps / 1Gbps Fibre Optics Network. It is of 80 kms
length and runs both inside the plant premises as well as Township. The remote areas or the areas
where network is not yet laid run on modems. Overall JSPL network includes 1300 + nodes. The entire
server farm is protected by using CISCO PIX 535E Firewall and CISCO 4210 Intrusion Protection
System. JSPL network is based on Three fold Hierarchy of switches and implements the VLAN concept
that include:

                                                                                           Page 56

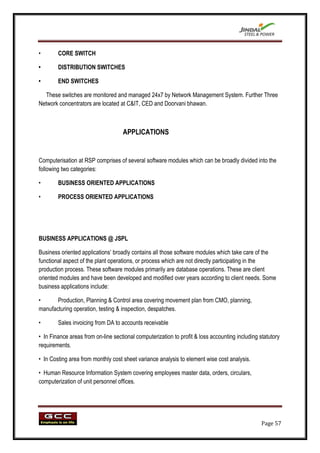

•       CORE SWITCH

•       DISTRIBUTION SWITCHES

•       END SWITCHES

  These switches are monitored and managed 24x7 by Network Management System. Further Three
Network concentrators are located at C&IT, CED and Doorvani bhawan.

                                    APPLICATIONS

Computerisation at RSP comprises of several software modules which can be broadly divided into the
following two categories:

•       BUSINESS ORIENTED APPLICATIONS

•       PROCESS ORIENTED APPLICATIONS

BUSINESS APPLICATIONS @ JSPL

Business oriented applications‟ broadly contains all those software modules which take care of the
functional aspect of the plant operations, or process which are not directly participating in the
production process. These software modules primarily are database operations. These are client
oriented modules and have been developed and modified over years according to client needs. Some
business applications include:

•      Production, Planning & Control area covering movement plan from CMO, planning,
manufacturing operation, testing & inspection, despatches.

•       Sales invoicing from DA to accounts receivable

• In Finance areas from on-line sectional computerization to profit & loss accounting including statutory
requirements.

• In Costing area from monthly cost sheet variance analysis to element wise cost analysis.

• Human Resource Information System covering employees master data, orders, circulars,
computerization of unit personnel offices.

                                                                                                 Page 57
• Employee Services area covering pay slip, PF slip, Income Tax, VRS schemes, incentive, bonus etc.
till trial balance.

• CMMS module covering preventive maintenance planning, shop scheduling, FMM equipment,
Cranes, Repair Shop (Electrical).

• Materials Management area from cataloging, indent, tender enquiry, order placement, inspection,
receipts, issues, budget control, ABC analysis, lead time analysis & MIS.

• Secondary Sales covering preparation of catalog of items from CDY, Idle Assets & Secondary
Products for Forward Auction, award of lots, Sale/Disposal Sale Order, Delivery/Release Order, total
SSSY operation.

• Town Services covering quarter allotment to employees & non-employees, shop allotment, private
party billing & revenue collection etc.

• Hospital area covering indoor patient registration, non-entitled patient billing & revenue collection,
central medicine store, dispensary & ward medicine accounting.

•       Plant Status for MD, EDs, GMs, HoDs and Plant Control.

•       CISF operations covering gate pass and loading sections.

                     PROCESS CONTROL SYSTEMS @ RSP

 A general process control computer system consists of the following levels of distribution of
responsibility, with two-way communication among peer-level as well as with higher levels:

• Level-1 - direct digital control of process using PLC, DCS (Digital Control System) and Operator HMI
(Human Machine Interface).

• Level-2 - supervisory control level, for process tracking and optimization using a server type of
computer and terminals.

• Level-3 - infra-level coordination computers for production, planning and control functions.

• Level-4 - scheduling, decision making, management information level.

                                                                                                   Page 58
INFORMATION TECHNOLOGY AND ENTERPRISE RESOURCE PLANNING

        ERP IS SHORT FOR ENTERPRISE RESOURCE PLANNING.

Enterprise resource planning (ERP) is business management software that allows an organization to
use a system of integrated applications to manage the business. ERP software integrates all facets of
an operation, including development, manufacturing, sales and marketing.

ERP SOFTWARE MODULES

ERP software consists of many enterprise software modules that are individually purchased, based on
what best meets the specific needs and technical capabilities of the organization. Each ERP module is
focused on one area of business processes, such as product development or marketing. Some of the
more common ERP modules include those for product planning, material purchasing, inventory control,
distribution, accounting, marketing, finance and HR.

As the ERP methodology has become more popular, software applications have emerged to help
business managers implement ERP in other business activities and may also incorporate modules for
CRM and business intelligence -- and present them as a single unified package.

The basic goal is to provide one central repository for all information that is shared by all the various
ERP facets in order to smooth the flow of data across the organization.

ERP VENDORS
Depending on your organization's size and needs there are a number of enterprise resource planning
software vendors to choose from in the large enterprise, midmarket and small business ERP markets.

                                                                                                    Page 59

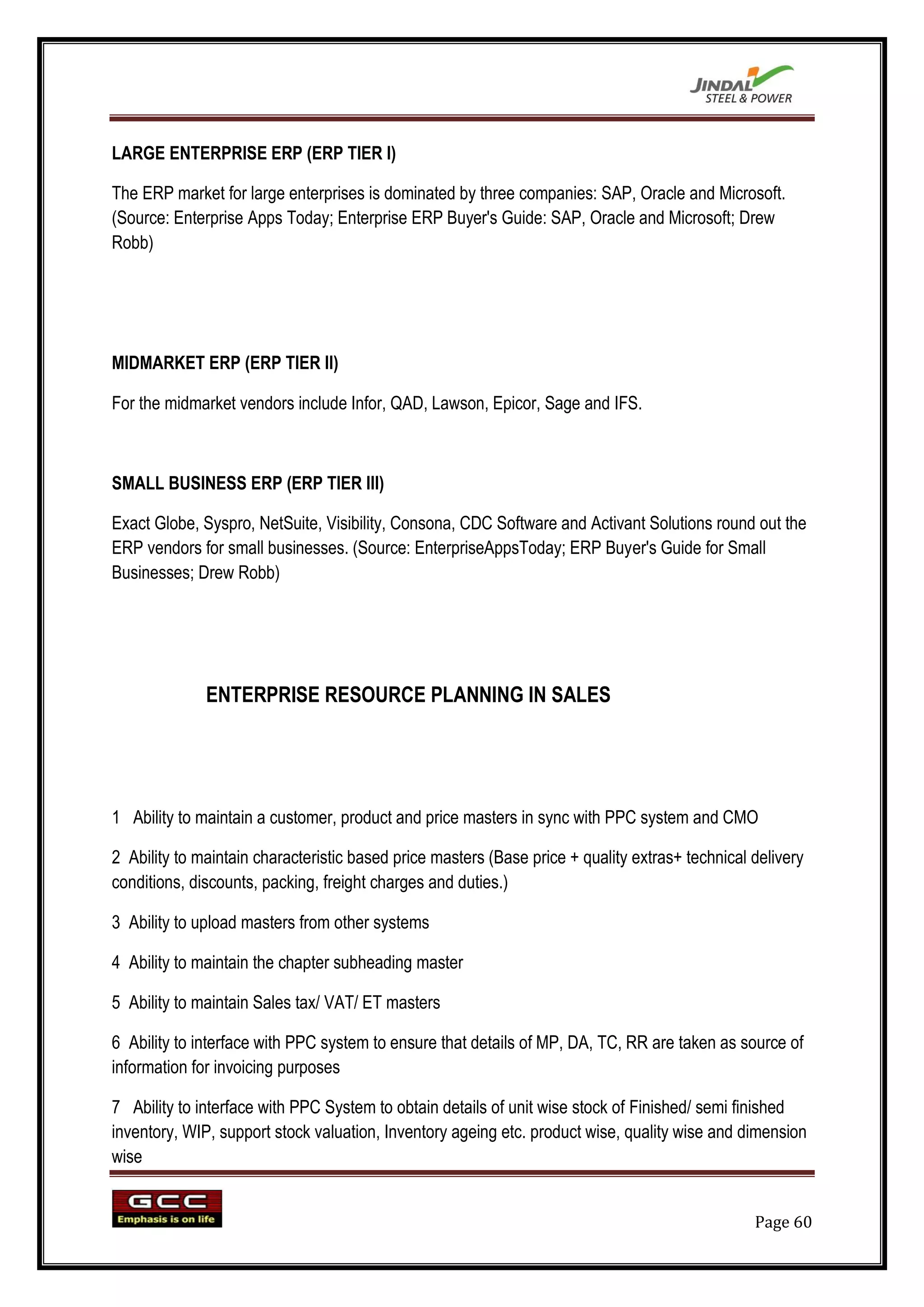

LARGE ENTERPRISE ERP (ERP TIER I)

The ERP market for large enterprises is dominated by three companies: SAP, Oracle and Microsoft.
(Source: Enterprise Apps Today; Enterprise ERP Buyer's Guide: SAP, Oracle and Microsoft; Drew
Robb)

MIDMARKET ERP (ERP TIER II)

For the midmarket vendors include Infor, QAD, Lawson, Epicor, Sage and IFS.

SMALL BUSINESS ERP (ERP TIER III)

Exact Globe, Syspro, NetSuite, Visibility, Consona, CDC Software and Activant Solutions round out the
ERP vendors for small businesses. (Source: EnterpriseAppsToday; ERP Buyer's Guide for Small
Businesses; Drew Robb)

              ENTERPRISE RESOURCE PLANNING IN SALES

1 Ability to maintain a customer, product and price masters in sync with PPC system and CMO

2 Ability to maintain characteristic based price masters (Base price + quality extras+ technical delivery
conditions, discounts, packing, freight charges and duties.)

3 Ability to upload masters from other systems

4 Ability to maintain the chapter subheading master

5 Ability to maintain Sales tax/ VAT/ ET masters

6 Ability to interface with PPC system to ensure that details of MP, DA, TC, RR are taken as source of
information for invoicing purposes

7 Ability to interface with PPC System to obtain details of unit wise stock of Finished/ semi finished
inventory, WIP, support stock valuation, Inventory ageing etc. product wise, quality wise and dimension
wise

                                                                                                 Page 60

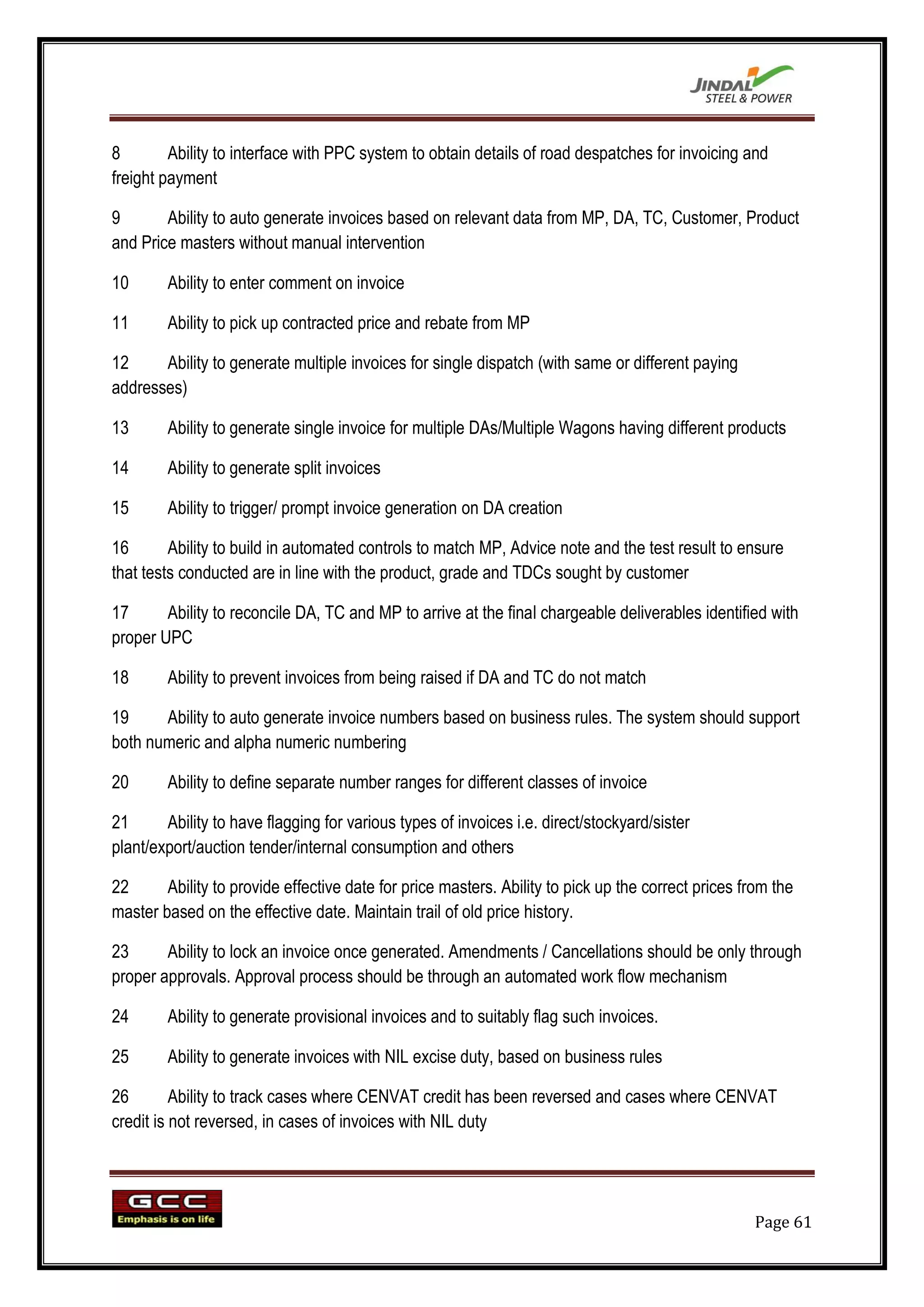

8        Ability to interface with PPC system to obtain details of road despatches for invoicing and
freight payment

9       Ability to auto generate invoices based on relevant data from MP, DA, TC, Customer, Product
and Price masters without manual intervention

10      Ability to enter comment on invoice

11      Ability to pick up contracted price and rebate from MP

12     Ability to generate multiple invoices for single dispatch (with same or different paying
addresses)

13      Ability to generate single invoice for multiple DAs/Multiple Wagons having different products

14      Ability to generate split invoices

15      Ability to trigger/ prompt invoice generation on DA creation

16       Ability to build in automated controls to match MP, Advice note and the test result to ensure
that tests conducted are in line with the product, grade and TDCs sought by customer

17      Ability to reconcile DA, TC and MP to arrive at the final chargeable deliverables identified with
proper UPC

18      Ability to prevent invoices from being raised if DA and TC do not match

19     Ability to auto generate invoice numbers based on business rules. The system should support
both numeric and alpha numeric numbering

20      Ability to define separate number ranges for different classes of invoice

21      Ability to have flagging for various types of invoices i.e. direct/stockyard/sister
plant/export/auction tender/internal consumption and others

22      Ability to provide effective date for price masters. Ability to pick up the correct prices from the
master based on the effective date. Maintain trail of old price history.

23      Ability to lock an invoice once generated. Amendments / Cancellations should be only through
proper approvals. Approval process should be through an automated work flow mechanism

24      Ability to generate provisional invoices and to suitably flag such invoices.

25      Ability to generate invoices with NIL excise duty, based on business rules

26        Ability to track cases where CENVAT credit has been reversed and cases where CENVAT
credit is not reversed, in cases of invoices with NIL duty

                                                                                                    Page 61

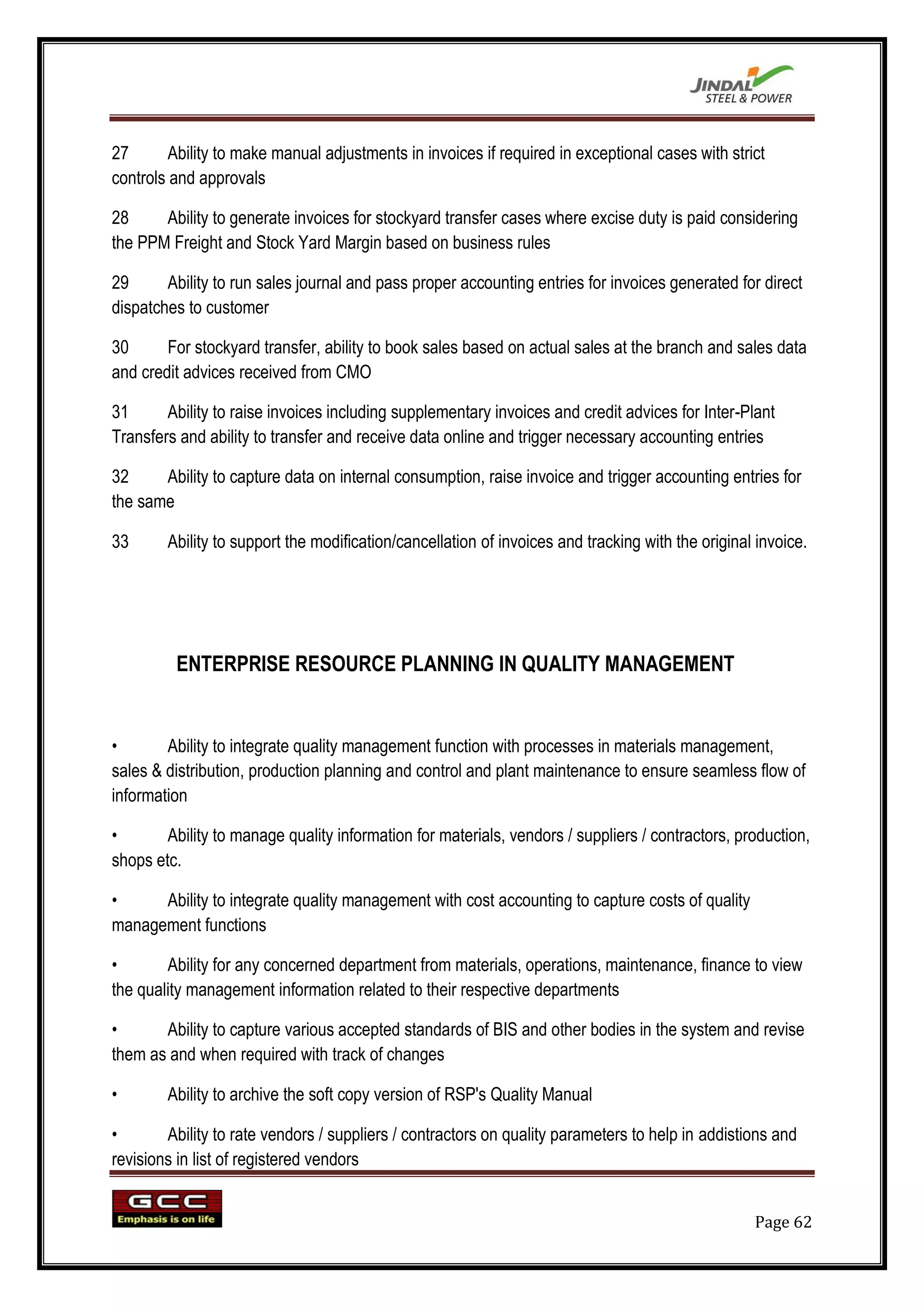

27       Ability to make manual adjustments in invoices if required in exceptional cases with strict
controls and approvals

28     Ability to generate invoices for stockyard transfer cases where excise duty is paid considering
the PPM Freight and Stock Yard Margin based on business rules

29      Ability to run sales journal and pass proper accounting entries for invoices generated for direct
dispatches to customer

30      For stockyard transfer, ability to book sales based on actual sales at the branch and sales data
and credit advices received from CMO

31      Ability to raise invoices including supplementary invoices and credit advices for Inter-Plant
Transfers and ability to transfer and receive data online and trigger necessary accounting entries

32     Ability to capture data on internal consumption, raise invoice and trigger accounting entries for
the same

33      Ability to support the modification/cancellation of invoices and tracking with the original invoice.

         ENTERPRISE RESOURCE PLANNING IN QUALITY MANAGEMENT

•       Ability to integrate quality management function with processes in materials management,
sales & distribution, production planning and control and plant maintenance to ensure seamless flow of
information

•       Ability to manage quality information for materials, vendors / suppliers / contractors, production,
shops etc.

•     Ability to integrate quality management with cost accounting to capture costs of quality
management functions

•       Ability for any concerned department from materials, operations, maintenance, finance to view
the quality management information related to their respective departments

•      Ability to capture various accepted standards of BIS and other bodies in the system and revise
them as and when required with track of changes

•       Ability to archive the soft copy version of RSP's Quality Manual

•       Ability to rate vendors / suppliers / contractors on quality parameters to help in addistions and
revisions in list of registered vendors

                                                                                                   Page 62

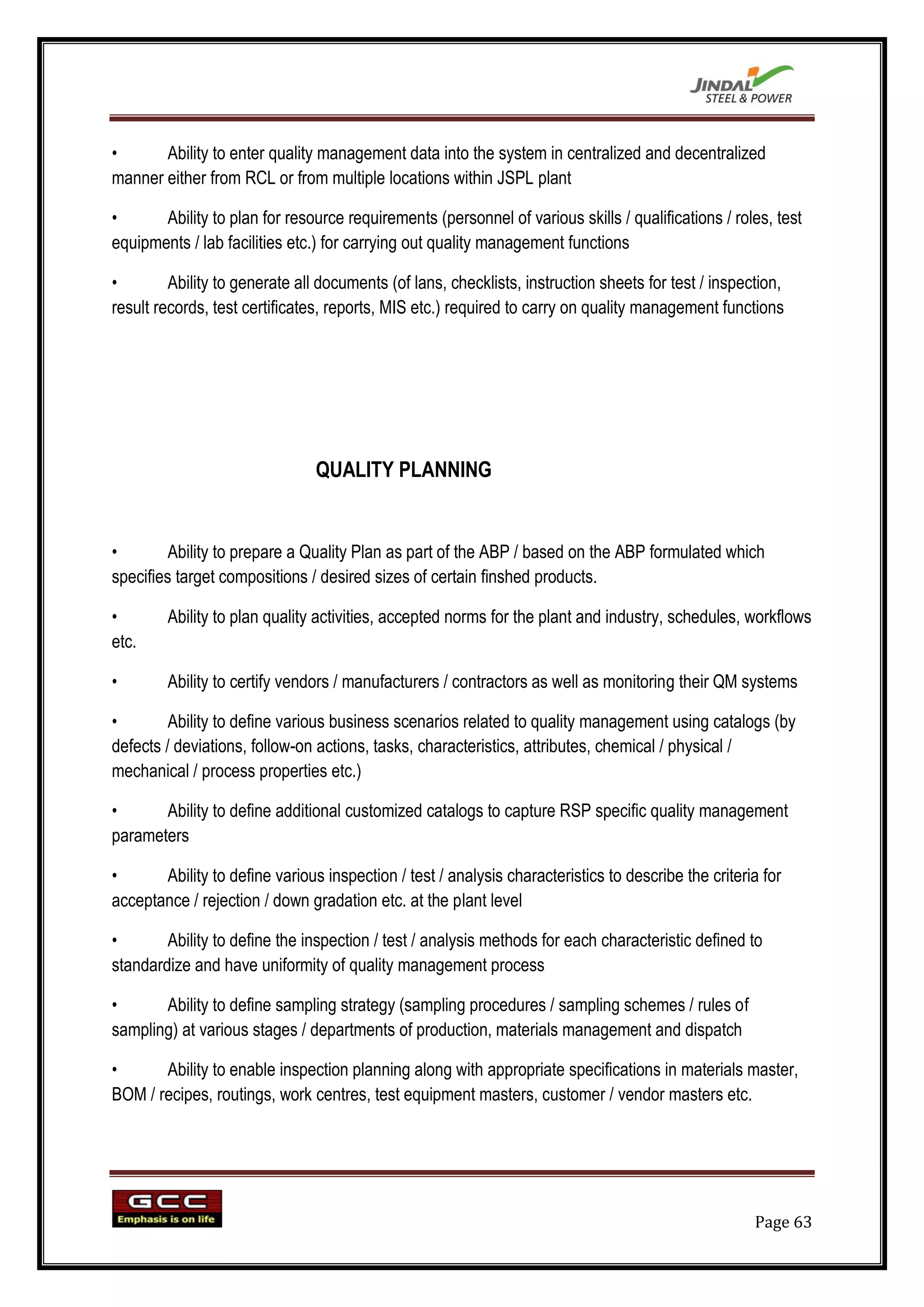

•      Ability to enter quality management data into the system in centralized and decentralized
manner either from RCL or from multiple locations within JSPL plant

•      Ability to plan for resource requirements (personnel of various skills / qualifications / roles, test
equipments / lab facilities etc.) for carrying out quality management functions

•        Ability to generate all documents (of lans, checklists, instruction sheets for test / inspection,
result records, test certificates, reports, MIS etc.) required to carry on quality management functions

                                QUALITY PLANNING

•        Ability to prepare a Quality Plan as part of the ABP / based on the ABP formulated which
specifies target compositions / desired sizes of certain finshed products.

•       Ability to plan quality activities, accepted norms for the plant and industry, schedules, workflows
etc.

•       Ability to certify vendors / manufacturers / contractors as well as monitoring their QM systems

•        Ability to define various business scenarios related to quality management using catalogs (by
defects / deviations, follow-on actions, tasks, characteristics, attributes, chemical / physical /
mechanical / process properties etc.)

•      Ability to define additional customized catalogs to capture RSP specific quality management
parameters

•      Ability to define various inspection / test / analysis characteristics to describe the criteria for
acceptance / rejection / down gradation etc. at the plant level

•       Ability to define the inspection / test / analysis methods for each characteristic defined to
standardize and have uniformity of quality management process

•      Ability to define sampling strategy (sampling procedures / sampling schemes / rules of
sampling) at various stages / departments of production, materials management and dispatch

•      Ability to enable inspection planning along with appropriate specifications in materials master,
BOM / recipes, routings, work centres, test equipment masters, customer / vendor masters etc.

                                                                                                     Page 63
•         Ability to prepare inspection / test schedules for the month / week / day considering available
test / inspection resources and test / inspection requirements from materials, operations, maintenance,
sales & dispatch to ensure better utilization

                                                                                                 Page 64
Page 65

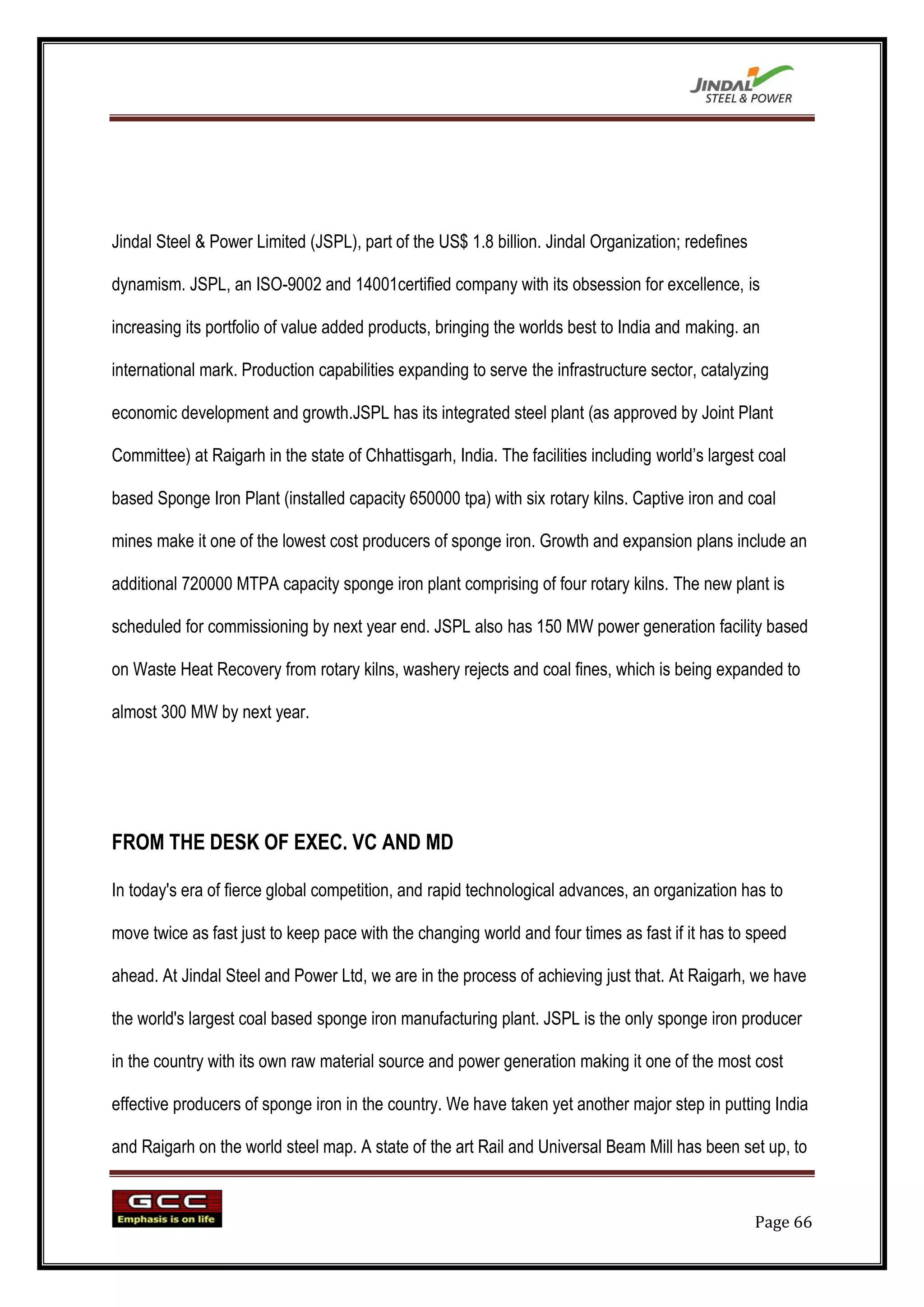

Jindal Steel & Power Limited (JSPL), part of the US$ 1.8 billion. Jindal Organization; redefines

dynamism. JSPL, an ISO-9002 and 14001certified company with its obsession for excellence, is

increasing its portfolio of value added products, bringing the worlds best to India and making. an

international mark. Production capabilities expanding to serve the infrastructure sector, catalyzing

economic development and growth.JSPL has its integrated steel plant (as approved by Joint Plant

Committee) at Raigarh in the state of Chhattisgarh, India. The facilities including world‟s largest coal

based Sponge Iron Plant (installed capacity 650000 tpa) with six rotary kilns. Captive iron and coal

mines make it one of the lowest cost producers of sponge iron. Growth and expansion plans include an

additional 720000 MTPA capacity sponge iron plant comprising of four rotary kilns. The new plant is

scheduled for commissioning by next year end. JSPL also has 150 MW power generation facility based

on Waste Heat Recovery from rotary kilns, washery rejects and coal fines, which is being expanded to

almost 300 MW by next year.

FROM THE DESK OF EXEC. VC AND MD

In today's era of fierce global competition, and rapid technological advances, an organization has to

move twice as fast just to keep pace with the changing world and four times as fast if it has to speed

ahead. At Jindal Steel and Power Ltd, we are in the process of achieving just that. At Raigarh, we have

the world's largest coal based sponge iron manufacturing plant. JSPL is the only sponge iron producer

in the country with its own raw material source and power generation making it one of the most cost

effective producers of sponge iron in the country. We have taken yet another major step in putting India

and Raigarh on the world steel map. A state of the art Rail and Universal Beam Mill has been set up, to

                                                                                                   Page 66
manufacture the world's longest rails 120 mts long for the Indian Railways and global markets. We are

also the pioneers when it comes to manufacturing H-beams & Columns in larger sizes for the

infrastructure and construction sectors. We are equally aware of our sense of duty as corporate citizens

and the determined pursuit of business opportunity and global markets. In fact, our vision is to develop

the backward and underdeveloped regions of India. Our facilities at Raigarh and Raipur fall under the

newly formed state of Chattisgarh. We have been and will continue to stand committed to the

progress of the state and it's people. At JSPL, we recognize that environmental protection is an integral

part of the company's activities. We are committed to conducting our business safely, ethically and in

an environmentally responsible manner that protects the natural resources and the environment in

which we live. Our environment-friendly initiatives have been recognised and rewarded too. Our

philosophy of moving up the value chain by increasing our portfolioof value added products continues.

A zeal to be ahead of others, to venture

where few dared has propelled us into ever increasing orbits of growth. The sectors we have chosen to

operate mean that we will be serving key nationalpriorities, even as we build profitable businesses and

create wealth for our shareholders. The unstinted support over the years from our investors, our clients,

business associates and well-wishers, has been a great asset and we hope to continue to have them

with us as we grow from strength to strength.

Naveen Jindal

                                                                                                 Page 67
Page 68
CORPORATE PROFILE

Jindal Steel & Power Limited (JSPL) part of the US $ 15 billion Jindal organization is in business of

steel production, power generation, mining, sponge iron, ferro chrome and heavy machinery. JSPL

Raigarh is 3 MTPA steel plant with world's largest coal-based sponge iron manufacturing facility and

340 MW captive power generation facility. The company has introduced innovative products like

parallel flange beams & columns, which command more than half of the market share & 120m long

finished rails.

The company is implementing 6 MTPA integrated steel plant at Angul in Orissa, 6 MTPA integrated

steel plant at Patratu in Jharkhand and a 1000 MW power plant at Raigarh through its subsidiary

company Jindal Power Limited (JPL). JSPL is also in the process of investing US $ 2.1 Billion in Bolivia

for setting up an integrated steel plant.

Jindal Steel & Power Limited (JSPL) Raipur is a Machinery Division of Jindal Steel & Power

Limited, Raigarh

                                                                                                 Page 69
The Heavy Machinery Division, Jindal Steel & Power Limited at Raipur was established in year 1992

with an objective to cater the requirement of companies within Jindal organization and other industries

in the region. The division manufactures heavy machinery equipment i.e. Slab Caster, Rolling Mills,

Structural Mills, Kilns, Blast Furnace, Sinter Plant etc. also we produce Steel Casting, Centrifugal

Castings, Ingots and we are also established our Pressure Vessel Division for our up-coming Angul

Projects and other Steel Plants. Now recently we have got certification of Indian Boiler Regulations-

1950, for manufacturing of equipments, machines like boilers etc. for Power Projects in India.

This state of art division has a manufacturing capacity of 20,000 MPTA along with a capacity of 30,000

MPTA of steel ingots and casting and compares with the best in the region. The division can produce

single piece steel casting up to 12 MT and has handling facility up to 150 MT.

A wide range of machinery has been manufactured and supplied to companies like L&T MHI, South

Eastern Coalfields, SAIL, Lafarge India, Garden Reach Ship Builders, HCL Kolkata, NMDC, Monet

Ispat, JSPL Raigarh, JSL Hisar, Jindal Angul, Patratu & JSW Bellary etc.

                                                                                                  Page 70
Page 71
HOT ROLLED PARALLEL FLANGE BEAMS AND COLUMN

Every product has at least one USP, which can become its strongest point-and help the product sell

more. The USP helps you position yourbrand distinctively. Another important component in fostering a

marketing style is Value Addition and Hot rolled parallel flange beams and column are most sought

after sections by structural engineers, architects and construction companies the world over.

Advantages of using Parallel Flanges Beams and Column over ISMIB-


 Greater choice of profile—with universal rolling method, there will be choice of large no. of

beams and column with different weight in kg/in and statically properties in comparison to traditional I-

beams on account of caliber rolling method.

                                                                                                  Page 72

 Facilitate bolted or welded construction— there is no taper in H beam flange. Flow drill

and Hollo-bolt helps to produce bolted joints with hollow sections.

  Ensured quality of material and construction—the Parallel Flanges Beams have

superiority in terms of strength, sectional efficiency, load bearing capacity, workability and economy in

comparison to traditional beams.

  Reduced steel consumption—with the adoption of new technology the JSPL beams are cost

effective because of less weight. The co. is able to save 15-30% of steel.

  Time-saving construction-pre-forined steel frames saves on construction time, they can be

erected very fast and metal decking at floors ensures fast track, formwork-free construction.


 Efficiency in construction-pre-fabricated and sleek steel reduces construction time which in

turn reduces related costs including reduced interest during construction and quicker revenue

generation.

                                                                                                  Page 73
 safety-everyone knows material weaken in fire, yet JSPL ignore this fact in design calculation.
 Fire

These are based on the strength of structural members at 20 degree C, and not on their reduced

strength at elevated temperature of 600,800,1000 degree C or more.

APPLICATIONS OF PARALLEL FLANGES BEAMS AND

COLUMNS


 Industrial Buildingsthe Parallel Flanges Beams have superiority in terms of strength, sectional

efficiency, load bearing capacity, workability and economy in comparison to traditional beams.

with the adoption of new technology the JSPL beams are cost effective because of less weight. The co.

isable to save 15-30% of steel. pre-forined steel frames saves on construction time, they can be

erected very fast and metal decking at floors ensures fast track, formwork-free construction.

pre-fabricated and sleek steel reduces construction time which in turn reduces related costs including

reduced interest during construction and quicker revenue generation.

everyone knows material weaken in fire, yet JSPL ignore this fact in design calculation. These are

based on the strength of structural members at 20 degree C, and not on their reduced strength

at elevated temperature of 600,800,1000 degree C or more.

 Multi-storey Buildings

 Road bridge composite construction

 buildings and car parks
Utility

                                                                                                    Page 74

Technological structures


 Railways


 Material handling system


 Ports and harbors

WORLDS LONGEST & INDIA „S ONLY 120M LONG “RAILS”

JSPL believes in understanding the minutes of details of rail customer in order to provide them with

foolproof solution, committed not only in supplying rails but in facilitating the building of a system of

modern rail track for the Indian railways. JSPL has entered into a technical collaboration agreement

with N7KKCorporation, Japan for technology transfer to produce superior quality, world‟s longest rails of

120m finished length, along with Parallel Flanges beams, column and Sheet piles for first time in the

country. The agreement covers „know-how‟ transfer encompassing steelmaking, secondary refining and

                                                                                                     Page 75
continuous casting up to rolling and finishing of long, rails and universal beams; deputation of NKK

multidisciplinary specialists at the JSPL plant; and training of JSPL personal at

NKK steel works in Japan.

NKK is already supplying rails for high-speed bullet trains, „Shinkansen‟ in Japan. This technical

collaboration shall enable production of long rails requiring far less joints in tracks, ushering a new era

in rail travel safety and introduction of fast trains in India a reality. Railways, the backbone Indian

economy covers 63,000 route kilometers. -It has the largest network in Asia and second largest in the

world. Carrying 13 million passenger and over 1.3 million tones of freight daily, it is most important

means of transport in the country. Efficient transportation system is essential for development of an

industry, business and trade and brings synergy in the development of region across state

boundaries. As a step toward forward integration JSPL is setting-up a rail & universal beam mill to

produce superior quality worlds longest, 120m long, finished rail for the first time in India. A Flash-butt

welding plant, with state-of-art technology, is also being installed to produce long welded rails

up to 480m for direct transportation to Indian Railways construction sites.

Advantages:

With the availability of 120 m long rails, there will be drastic reduction of weld population in Indian rail

tracks (from 160 welds per track km presently to 17) resulting enhances safety and cost reduction. The

performance of Indian Railways would improve on account of enhanced safety, increased

reliability, comfort and prolonged rail life.

                                                                                                      Page 76
Rail Steel‟s Quality & Product Range:

Our comprehensive range of rail steels can be broadly classified as:Normal grade typified by 710

N/mm2 minimum UTS Wear resistant Grade typified by 880 N/ mm2 minimum UTS to 1080 N/mm2

UTS. Rails with higher UTS value as may be specified by international or domestic customers can be

produced. Rail steels are produced in bothstandard carbon grades and micro-alloyed grades to meet

the strength and quality requirement. The quality assurance system of JSPL today is certified by BSI-

London for Quality BS:EN 9002:2000 and BS: EN 14001:1996 for Environmental Management System.

Besides autonomous responsibility for self-checking, wherein products are qualified by self-certification,

i.e. extensive internal and external inspection in conformity with customer requirements; we also follow

the system of approval by third party inspections prior to dispatch.

                                                                                                 Page 77
Today, the standard requirements of rails must meet the operating needs ofthe railways for at least 20

years. It is this stringent quality norm which guides the company to manufacture products of high

standards, placing JSPL at the forefront in the supply of rails.

Specifications of Rails:

JSPL rails are being rolled to different sections ranging from BS-75R (37.1 Kg/m) to UIC-70 (70 Kg/m):

conforming to Indian Railways as well as internationalspecifications. Rails can be supplied in

                                                                                                 Page 78
customized finished lengths ranging from 13 m to 120 m and flashbutt welded rails from 240 m up to

480 m. Some of the important specifications are listed below:

S. No. Rail Sections Sectional Weight (kg/m) Specification*

1. P-75 74.41 GOST

2. UIC-60 60.34 UIC

3. UIC-54 E 53.823 UIC

4. IRS-52 51.89 IRS

5. UIC-50 50.88 UIC

6. TCDD-49 46.303 S-49

7. 48 Kg SAS 47.60 SAS

8. BS-90R 44.65 BS

9. BS-75R 37.1 B

                                                                                             Page 79
POWER

expansion to 350 MW on anvil. JSPL generates power to meet its captive requirements. The surplus

power is supplied to Chhattisgarh state Electricity Board. The current generation of power is 150MW.

Work on another 55MW plant has also been completed. Building upon the strength of our unshakeable

foundations, JSPL is poised for a quantum leap in the core sector of power, contributing to the growing

needs of the nation. At JSPL, we generate power to meet our captive requirements. In 1991, we

entered this vital core sector by utilising waste heat from the rotary kiln boilers and the coal rejects of

the washery. JSPL has 255 MW power generation facility with a capacity

                                                                                                     Page 80
JSPL is one of India's most economical power producers in the private sector. Jindal Power Limited has

been established to sharpen our focus, leading to planned growth with a 1,000 MW. Thermal power

plant being established in Raigarh district, about 40 kms from our existing

plant. An MOU with the State Government has been signed and preliminary work on this project has

already commenced. The serious intent of the JSPL foray into power can be gauged from its

accelerated pace of expansion and meeting commitments not only on time but well in time. The thrust

into this core sector is not only in keeping with our philosophy of creating opportunities where others

see problems, but is also in complete synergy with the businesses we already are in. Our vision of

utilising existing in-house strengths to fuel further growth has made us a force to reckon with. JSPL has

a long-term commitment to this vital core sector. Jindal Power Limited will serve to further sharpen our

focus on the power sector and thus lead to faster growth.

SPONGE IRON

The world's largest coal-based sponge iron facility

                                                                                                  Page 81
JSPL is one of the lowest-cost producers of sponge iron in India. Backward integration

has given JSPL the distinction of being the only sponge iron manufacturer with its own captive

raw material resources and power generation. This has enabled JSPL to monitor both price and

quality of its products. At Raigarh, JSPL has the world's largest coal-based sponge iron manufacturing

facility, with an installed capacity of 1.35M TPA, using ten rotary kilns. Sponge iron was the first

production facility at the Raigarh

plant, commissioned in 1991. In India, JSPL is the market leader in coalbased sponge iron, enjoying a

market share of 22%. Today a major portion of our production is used for in-house manufacture of steel

at JSPL and the other companies in the Jindal Organisation. As a key raw material for the manufacture

of steel, our focus on sponge iron continues. The increased production is geared to meet our expanding

capacities for value-added steel products in the years ahead.

MINING- IRON ORE, GOAL & COAL WASHING

                                                                                                       Page 82
JSPL has its own iron ore mines at Tensa; district Sundergarh, Orrisa which produces 550,000 million

tonne per annum (mtpa) of iron ore to meet the part requirement of Sponge Iron Plant. The company

has its captive coal mines at Dongamahua, District Raigarh, and Chattisgarh with a capacity of

2.0 mtpa. Since the coal is of very poor grade and quality, it has to be beneficiated. Hence, a coal

washery with a capacity of 2.5 mtpa to wash 47- 48% a coal ash to 26% has been commissioned and is

operating successfully.

The washery meets the requirements of sponge iron plant. Middling from the washery are being used

for generation of captive power to tune of 100 MV. The captive mine is core strength of the company.

FERRO CHROME

                                                                                                 Page 83
Ferro chrome is an essential component in the manufacture of stainless steel and special steel. JSPL

manufactures ferro chrome through the continuous smelting of chrome ore, coke, coal and quartz at the

submerged arc furnace (SAF). At temperatures of 1600-1700oC, the chrome ore gets reduced by the

carbon of the reductants. The SAF is tapped at regular intervals depending on the power input. Metal

and slag come out together and by virtue of the higher specific gravity, the metal settles in the first

receptacle. After solidification, the metal is removed from the receptacle and crushed to the required

sizes. The emphasis on quality control is strict and in accordance with the stringent requirements of

international standards. High-grade chrome ore is made available from captive chrome ore mines in

Sukinda Valley of Orissa. Throughout the manufacturing process, special emphasis is laid on ensuring

quality of the material at all levels. The plant is fully equipped with a state - of - the - art laboratory,

complete with the latest high - techtesting facilities at par with the best manufacturers in the world. From

each tapping, control samples are collected and analysed so as to maintain the international standards

of product quality. Almost the entire production of ferro chrome(36,000 MTPA) is committed to India's

leading manufacturer of stainless steel. An increase in production capacity is on the anvil and

global markets are being tapped to sell the increased production.

                                                                                                        Page 84
STEEL

Steel at our Raigarh plant is being manufactured using the Electric Arc Furnace. The steel melt shop

(SMS) is equipped with ladle furnace and vacuum degassing and has continuous casting facilities for

wide slabs, rounds and blooms. The capacity of SMS is 4, 00,000 MTPA. Steel at our Raigarh plant is

being manufactured using the Electric Arc Furnace. The steel melt shop (SMS) is equipped with ladle

furnace and vacuum degassing and has continuous casting facilities for wide slabs, rounds and

blooms. The steel making capacity at present is 1.15 million TPA. JSPL has recently signed an MoU

with the State Government of Orissa to set up a 2 million tonne steel plant with an investment of

Rs.13,500 carores which would be expanded to 6 million tonne and another MoU has been signed with

the State Government of Jharkhand to set up a 5 million steel plant with an investment of Rs.12,000

crores.

                                                                                                Page 85

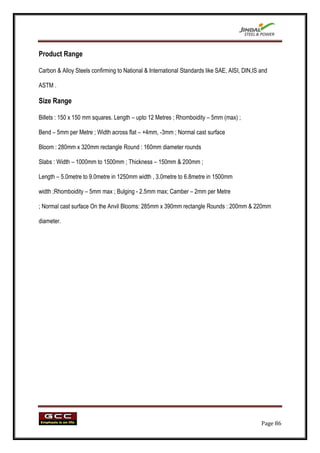

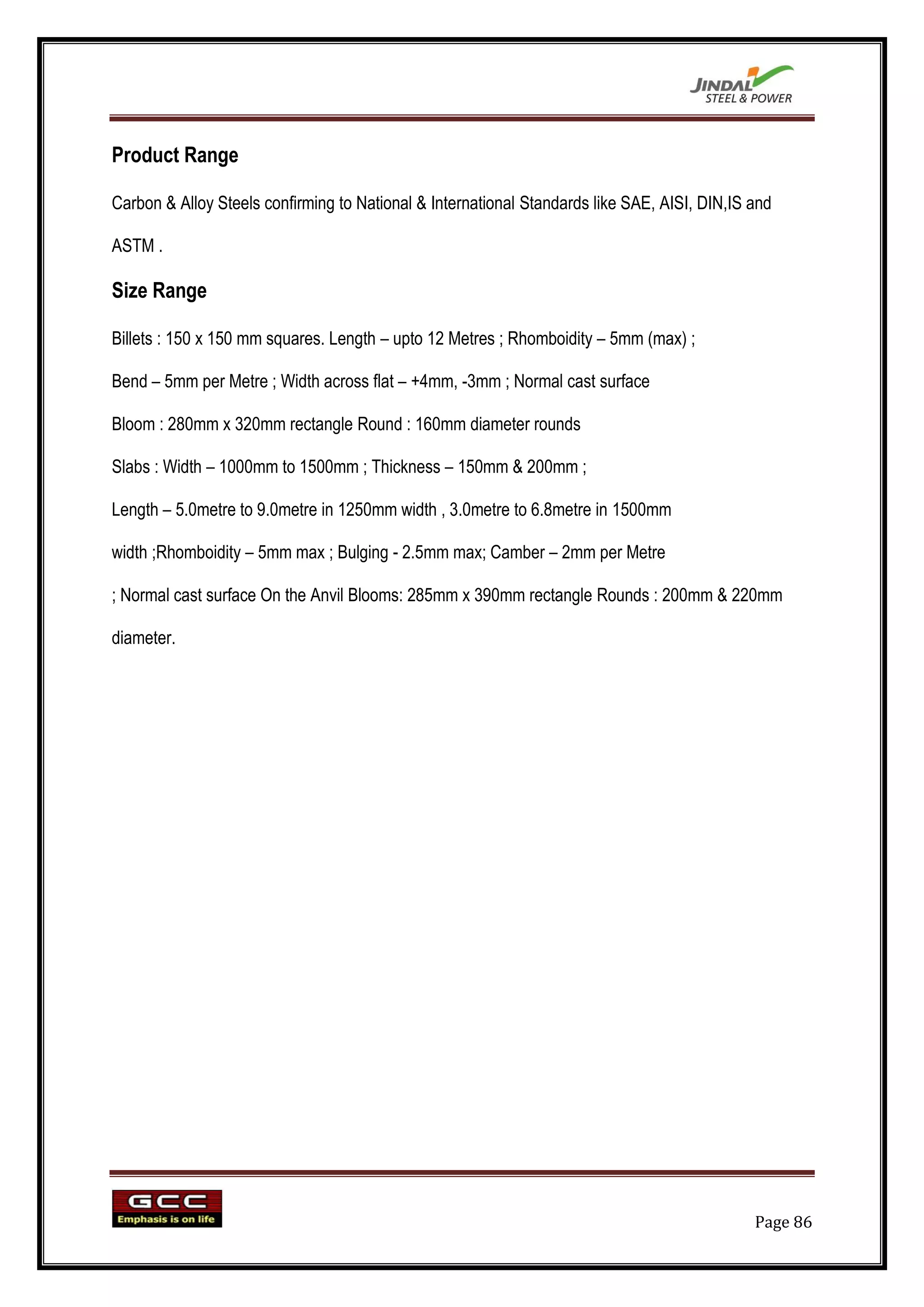

Product Range

Carbon & Alloy Steels confirming to National & International Standards like SAE, AISI, DIN,IS and

ASTM .

Size Range

Billets : 150 x 150 mm squares. Length – upto 12 Metres ; Rhomboidity – 5mm (max) ;

Bend – 5mm per Metre ; Width across flat – +4mm, -3mm ; Normal cast surface

Bloom : 280mm x 320mm rectangle Round : 160mm diameter rounds

Slabs : Width – 1000mm to 1500mm ; Thickness – 150mm & 200mm ;

Length – 5.0metre to 9.0metre in 1250mm width , 3.0metre to 6.8metre in 1500mm

width ;Rhomboidity – 5mm max ; Bulging - 2.5mm max; Camber – 2mm per Metre

; Normal cast surface On the Anvil Blooms: 285mm x 390mm rectangle Rounds : 200mm & 220mm

diameter.

                                                                                              Page 86
Page 87
SWOT ANALYSIS

While conducting Organisational Study of any of the organisation it is important to take into account not

only the organisation‟s business but also its competitors business as well.

The following description will highlight the Strength, Weakness, Opportunity and Threats of Jindal Steel

and Power

 STRENGTH:-

    1) Competitor‟s price of product is most powerful weapon for the company.

    2) Highly equipped and modern technological manufacturing plant.

    3) Quality control of product in each stage and technological quality checking of each product.

    4) Using highly competitive Raw material

    5) Sufficient Human Resource power

    6) Customer Satisfaction through supplying product in time

    7) Providing good services to customer

    8) Skilled and highly Experienced Department Heads.

 WEAKNESS:-.

    1) Less scope for diversification of product.

 OPPORTUNITY:-

    1) Growing Steel and Power Industry

                                                                                                 Page 88
2) Availability of skilled labours and policy Support.

 3) Huge export opportunity

 4) Availability of well connected road network

THREATS:-

 1) Fluctuating policies of the government and ecological imbalances.

 2) Competitors.

                                                                        Page 89
MISSION, VISION & VALUES

Vision

“To be a globally admired organization that enhances the quality of life of all stakeholders through

sustainable industrial and business development”

Mission

We aspire to achieve business excellence through-

    •    The spirit of entrepreneurship and innovation

    •    Optimum utilization of resources

    •    The highest ethics and standards

    •    Maximizing returns to stakeholders

Values

    •    Passion for people

    •    Business excellence

    •    Integrity, ownership and and source of belonging

                                                                                                 Page 90
•   Sustainable development

                              Page 91
Page 92

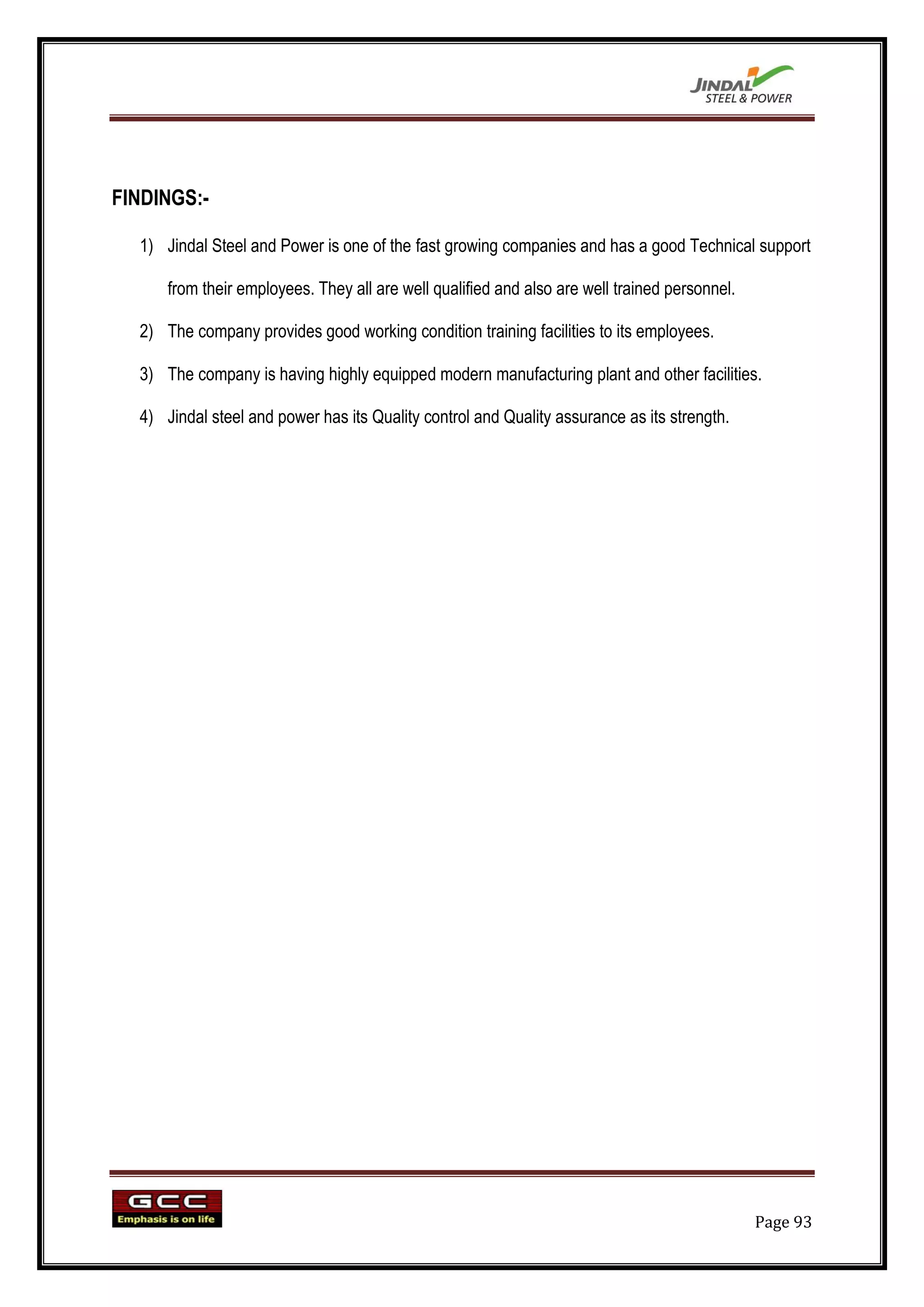

FINDINGS:-

  1) Jindal Steel and Power is one of the fast growing companies and has a good Technical support

      from their employees. They all are well qualified and also are well trained personnel.

  2) The company provides good working condition training facilities to its employees.

  3) The company is having highly equipped modern manufacturing plant and other facilities.

  4) Jindal steel and power has its Quality control and Quality assurance as its strength.

                                                                                               Page 93

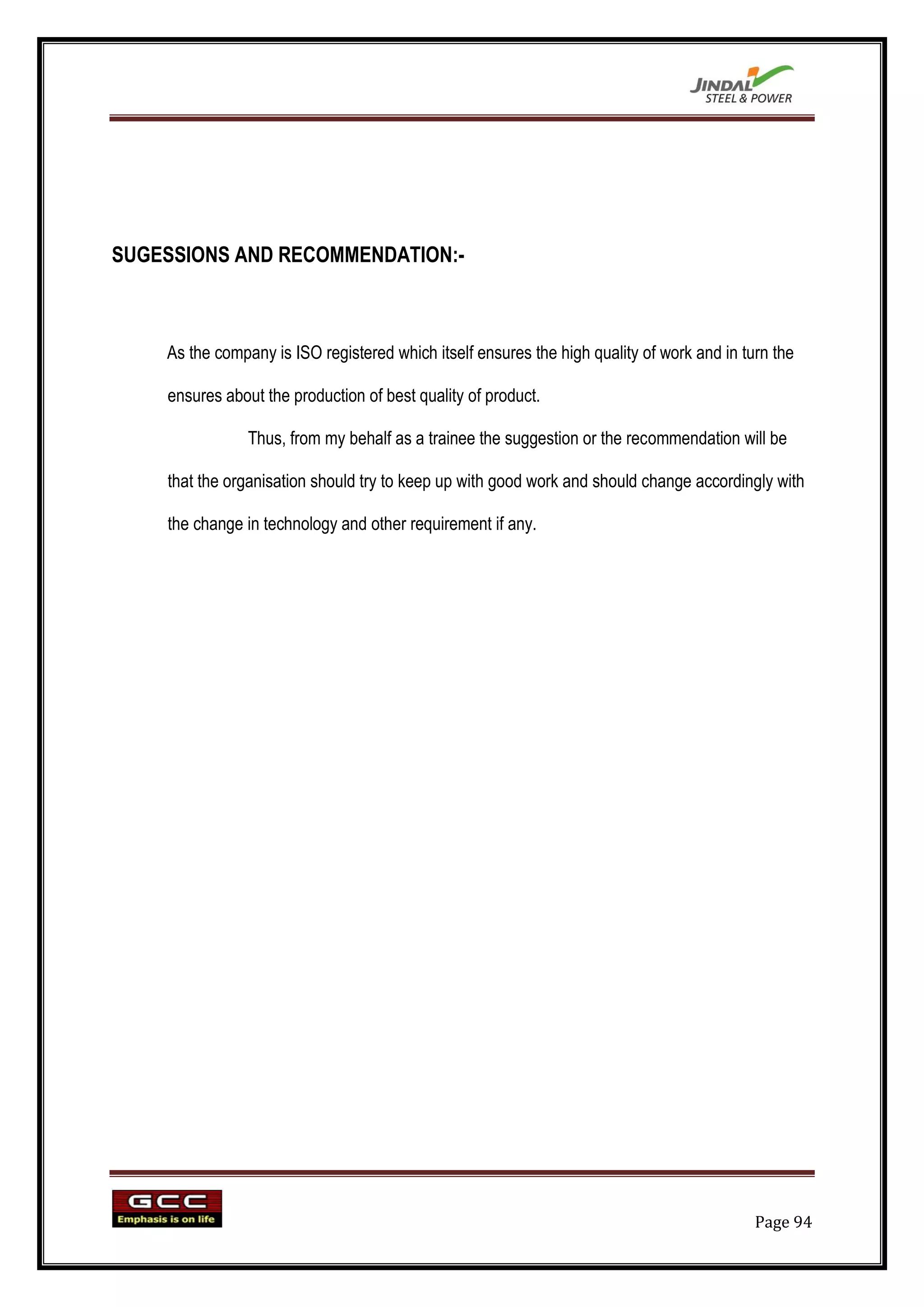

SUGESSIONS AND RECOMMENDATION:-

    As the company is ISO registered which itself ensures the high quality of work and in turn the

    ensures about the production of best quality of product.

                Thus, from my behalf as a trainee the suggestion or the recommendation will be

    that the organisation should try to keep up with good work and should change accordingly with

    the change in technology and other requirement if any.

                                                                                            Page 94

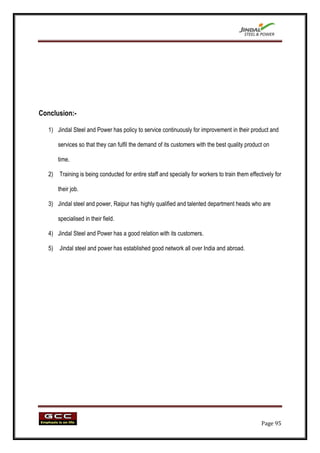

Conclusion:-

   1) Jindal Steel and Power has policy to service continuously for improvement in their product and

       services so that they can fulfil the demand of its customers with the best quality product on

       time.

   2) Training is being conducted for entire staff and specially for workers to train them effectively for

       their job.

   3) Jindal steel and power, Raipur has highly qualified and talented department heads who are

       specialised in their field.

   4) Jindal Steel and Power has a good relation with its customers.

   5) Jindal steel and power has established good network all over India and abroad.

                                                                                                 Page 95
Page 96
Page 97
BIBLIOGRAPHY:-

  1) JSPL Brochures and Manuals.

  2) Website- www.jindalsteelpower.com.

  3) Newspapers.

  4) Search Magazines.

  5) Electrical media.

                                          Page 98

Jindal

  • 1.
    An Organisational study at Jindal Steel And power Submitted in the partial fulfillment of the requirement for the Degree of Master of Business Administration Of Bangalore University Submitted by Nischal Kumar Solanki Reg no.:11RSCMA062 Under the guidance of Prof.Shayan Pal Garden City College Bangalore-560049 Page 1
  • 2.
    DECLARATION I, Nischal KumarSolanki hereby declare that Industrial Training Report titled “An Organisational Study at Jindal Steel And Power, Raipur” submitted in the partial fulfillment of the requirement for the Degree of Master of Business Administration is my original work and is not submitted for the award of any Degree, Diploma, Fellowship or other similar title or awards. Place: Bangalore NISCHAL KUMAR SOLANKI Date: Reg no: 11RSCMA062 Page 2
  • 3.
    TABLE OF CONTENTS Chapter Contents Number 1. Industry Profile.  About BPO.  About Parent Company.  About diversified Areas of Parent Company.  Company Profile About Aegis  Vision, Mission, Motive. 2. Organization structure of JSPL, RAipur. 3. Functional Area.  Human Resource Management.  Marketing Department.  Material Management Department.  Information Technology & ERP.  Vigilance Department. 4. SWOT Analysis of the Company.  Strength.  Weakness.  Opportunity.  Threats. 5 Findings and Suggestion. Findings. Suggestions. 6 Conclusion. 7 Bibliography Page 3
  • 4.
  • 5.
  • 6.
    Industry Profile –Steel Industry Indian steel industry plays a significant role in the country‟s economic growth. The major contribution directs the attention that steel is having a stronghold in the traditional sectors, such as infrastructure & constructions, automobile, transportation, industrial applications etc. Moreover, steel variant stainless steel is finding innovative applications due to its corrosion resistive property. India is the fifth largest steel producer at the global front and struggling to become the second largest producer in the coming years. The country has acquired a central position on the global steel map with its giant steel mills, acquisition of global scale capacities by players, continuous modernization & up gradation of old plants, improving energy efficiency, and backward integration into global raw material sources. Global steel giants from across the world have shown interest in the industry due to its phenomenal performance. For instance - the crude steel production in India registered a year-on-year growth of 6.4% in 2010 and reached 66.8 Million Metric Tons. India has emerged as the fourth largest steel producing nation in the world, as per the recent figures release by World Steel Association in April 2011. In 2010, India was the 5th largest producer, after China, Japan, USA and Russia had recorded a growth of 11.3% in steel production as compared to 2009. Overall domestic crude steel production grew at a compounded annual growth rate of 8.4% during 2005-06 to 2009-10. The Indian steel industry accounted for around 5% of the world‟s total production in 2010. Page 6
  • 7.
    new research report“Indian Steel Industry Outlook to 2012” says that the, Indian crude steel production will grow at a CAGR of around 10% during 2010-2013. Moreover, with the government proactive incentive plans to boost economic growth by injecting funds in various industries, such as construction, infrastructure, automobile, and power will drive the steel industry in future. The report also reveals that, steel consumption in India is expected to grow significantly in coming years as per capita finished steel consumption is far less than its regional counterparts. The demand for steel in the country is currently growing at the rate of over 8% and it is expected that the demand would grow over by 10% in the next five years. However, the steel intensity in the country remains well below the world levels. Our per capita consumption of steel is around 110 pounds as compared to 330 Pounds for the global average. This indicates that there is a lot of potential for increasing the steel consumption in India. Immense growth potential in Indian Steel Sector Domestic crude steel production grew at a compounded annual growth rate of 8.4% in the last few years. Crude steel production capacity of the country is projected to be around 110 million tonne by 2012-13. 222 Memorandum of Understandings (MOU) have been signed with various states for planned capacity of around 276 million tonnes by 2019-20. Investments at stake are to the tune of $187 billion in the Steel sector. Increase in the demand of steel in India is expected to be 14% against the global average of 5-6% due to its strong domestic economy, massive infrastructure needs and expansion of industrial production. Page 7
  • 8.
    Demand of steelin the major industries like infrastructure, construction, housing, automotive, steel tubes and pipes, consumer durables, packaging and ground transportation. Target for $ 1 trillion of investments in infrastructure during the 12th Five Year Plan. Infrastructure projects (like Golden Quadrilateral and Dedicated Freight Corridor) will give boost to the demand in the steel sector in near future. Projected New Greenfield & up-gradation of existing Airport shall keep the momentum up. Increased demand of specialized steel in hi-tech engineering industries such as power generation, automotive petrochemicals, fertilizers etc. Page 8
  • 9.
  • 10.
    EVP-JSPL RAIPUR PRESSURE SHARED DIVISION MACHINERY VESSEL DIVISION DIVISION SR. DGM- MKTG GM- P&TS SR.DGM-P&A,HR HEAD- PVD AGM- PUR./STORES &HSE SR-DGM- DGM- F&A MGR- CIVIL PRODUCTION SR-DGM-PLANT A& MGR.-QA EXPANSION PROJECT SR. DGM-OPRN. JR. MGR.-INT. AUDIT DGM- FURNACE DY. MGR- IT Page 10
  • 11.
  • 12.
    OF FUNCTIONAL AREASTHE JSPL, RAIPUR  HUMAN RESOURCE MANAGEMENT  MARKETING  MATERIALS MANAGEMENT  INFORMATION TECHNOLOGY AND ERP  VIGILANCE DEPARTMENT Page 12
  • 13.
    HUMAN RESOURCE DEVELOPMENT HumanResource Development (HRD) is the frameworks for helping employees develop their personal and organizational skills, knowledge, and abilities. Human Resource Development includes such opportunities as employee training, employee career development, performance management and development, coaching, mentoring, succession planning, key employee identification, tuition assistance, and organization development. The focus of all aspects of Human Resource Development is on developing the most superior workforce so that the organization and individual employees can accomplish their work goals in service to customers. Organizations have many opportunities for human resources or employee development, both within and outside of the workplace. Human Resource Development can be formal such as in classroom training, a college course, or an organizational planned change effort. Or, Human Resource Development can be informal as in employee coaching by a manager. Healthy organizations believe in Human Resource Development and cover all of these bases. The field of HRD or Human Resource Development encompasses several aspects of enabling and empowering human resources in organization. Whereas earlier HRD was denoted as managing people in organizations with emphasis on payroll, training and other functions that were designed to keep employees happy, the current line of management thought focuses on empowering and enabling them to become employees capable of fulfilling their aspirations and actualizing their potential. This shift in the way human resources are treated has come about due to the prevailing notion that human resources are sources of competitive advantage and not merely employees fulfilling their job responsibilities. The point here is that the current paradigm in HRD treats employees as value creators and assets based on the RBV or the Resource Based View of the firm that has emerged in the SHRM (Strategic Human Resource Management) field. The field of HRD spans several functions across the organization starting with employee recruitment and training, appraisals and payroll and extending to the recreational and motivational aspects of employee development. Indeed, one reason for the emergence of the RBV or the SHRM paradigm is that with the advent of the service sector and the greater proportion of companies in the service sector, employees are not merely a factor of production like land, labour and capital but in fact, they are sources of competitive advantage. This is characterized by many CEO‟s calling employees their chief assets and valuing their contribution accordingly. As a matter of fact, many IT and Page 13
  • 14.
    Financial Services companiesroutinely refer to employees as the value creators and value enhancers rather than just resources doing their job. What this has meant is that the field of HRD has become prominent and important for organizations and has morphed into a function that takes its place among other support functions in organizations and indeed, it is the main driver of competitive advantage. Further, the field of HRD now has taken on a role that goes beyond employee satisfaction and instead, the focus now is on ensuring that employees are delighted with the working conditions and perform their jobs according to their latent potential which is brought to the fore. This has resulted in the HRD manager and the employees of the HRD department becoming partners in the organization‟s progress instead of just yet another line function. Further, the HR managers now routinely interact with the functional managers and the people managers to ensure high levels of job satisfaction and fulfilment. The category of people managers is a role that has been created in many multinational companies like Fidelity and IBM to specifically look into the personality related aspects of employees and to ensure that they bring the best to the table. Finally, HRD is no longer just about payroll or timekeeping and leave tracking. On the other hand, directors of HRD in companies like Infosys are much sought after for their inputs into the whole range of activities spanning the function and they are expected to add value rather than just consume resources. With this introduction, we will be moving into the module covering HRD with each aspect of the HRD function and the associated topics being covered here. It is hoped that the readers would gain an overall perspective about HRD after going through the HRD module. This module covers the HRD function in organizations from a wide variety of perspectives. At the outset, after the introduction to the module in the previous article, it is time to look at some theoretical perspectives about the HRD function. When the field of management science and organizational behaviour was in its infancy, the HRD function was envisaged as a department whose sole role was to look after payroll and wage negotiation. This was in the era of the assembly line and manufacturing where the HRD function‟s purpose was to check the attendance of the employees, process their pay and benefits and act as a mediator in disputes between the management and the workers. Concomitant with the rise of the services sector and the proliferation of technology and financial services companies, the role of the HRD function changed correspondingly. For instance, the RBV or the Resource Based View of organizations was conceptualized to place the HRD function as a department that would leverage the human resources from the perspective of them being sources of strategic advantage. Page 14
  • 15.
    The shift inthe way the human resources were viewed as yet another factor of production to being viewed as sources of competitive advantage and the chief determinant of profits was mainly due to the changing perceptions of the workforce being central to the organization‟s strategy. For instance, many software and tech companies as well as other companies in the service sector routinely identify their employees as the chief assets and something that can give them competitive advantage over their rivals. Hence, the HRD function in these sectors has evolved from basic duties and is now looked upon as a critical support function. With the advent of globalization and the opening up of the economies of several nations, there was again a shift in the way the HRD function was conceptualized. In line with the RBV and the view of the resources as being international and ethnically diverse, the HRD function was thought of to be the bridge between the different employees in multiple locations and the management. Further, the present conceptualization also means that employees have to be not only motivated but also empowered and enabled to help them actualize their potential. The point here is that no longer were employees being treated like any other asset. On the contrary, they were the centre of attraction and attention in the changed paradigm. This called for the HRD function to be envisaged as fulfilling a role that was aimed at enabling and empowering employees instead of being just mediators and negotiators. Finally, the theory of HRD also morphed with the times and in recent years, there has been a perceptible shift in the way the HRD function has come to encompass the gamut of activities ranging from routine tasks like hiring and training and payroll to actually being the function that plays a critical and crucial role in the employee development. The theory has also transformed the function from being bystanders to the organizational processes to one where the HRD function is the layer between the management and employees to ensure that the decisions made at the top are communicated to the employees and the feedback from the employees is likewise communicated to the top PERSONNEL MANAGEMENT Personnel management can be defined as obtaining, using and maintaining a satisfied workforce. It is a significant part of management concerned with employees at work and with their relationship within the organization. According to Flippo, “Personnel management is the planning, organizing, compensation, integration and maintainance of people for the purpose of contributing to organizational, individual and societal goals.” Page 15
  • 16.
    According to Brech,“Personnel Management is that part which is primarily concerned with human resource of organization.” NATURE OF PERSONNEL MANAGEMENT 1. Personnel management includes the function of employment, development and compensation- These functions are performed primarily by the personnel management in consultation with other departments. 2. Personnel management is an extension to general management. It is concerned with promoting and stimulating competent work force to make their fullest contribution to the concern. 3. Personnel management exist to advice and assist the line managers in personnel matters. Therefore, personnel department is a staff department of an organization. 4. Personnel management lays emphasize on action rather than making lengthy schedules, plans, work methods. The problems and grievances of people at work can be solved more effectively through rationale personnel policies. 5. It is based on human orientation. It tries to help the workers to develop their potential fully to the concern. 6. It also motivates the employees through it‟s effective incentive plans so that the employees provide fullest co-operation. 7. Personnel management deals with human resources of a concern. In context to human resources, it manages both individual as well as blue- collar workers. ROLE OF PERSONNEL MANAGER Personnel manager is the head of personnel department. He performs both managerial and operative functions of management. His role can be summarized as : 1. Personnel manager provides assistance to top management- The top management are the people who decide and frame the primary policies of the concern. All kinds of policies related to personnel or workforce can be framed out effectively by the personnel manager. 2. He advices the line manager as a staff specialist- Personnel manager acts like a staff advisor and assists the line managers in dealing with various personnel matters. 3. As a counsellor,- As a counsellor, personnel manager attends problems and grievances of employees and guides them. He tries to solve them in best of his capacity. 4. Personnel manager acts as a mediator- He is a linking pin between management and workers. 5. He acts as a spokesman- Since he is in direct contact with the employees, he is required to act as representative of organization in committees appointed by government. He represents company in training programmes. Page 16
  • 17.
    FUNCTIONS OF PERSONNELMANAGEMENT Following are the four functions of Personnel Management: 1. Manpower Planning 2. Recruitment 3. Selection 4. Training and Development Manpower Planning which is also called as Human Resource Planning consists of putting right number of people, right kind of people at the right place, right time, doing the right things for which they are suited for the achievement of goals of the organization. Human Resource Planning has got an important place in the arena of industrialization. Human Resource Planning has to be a systems approach and is carried out in a set procedure. The procedure is as follows: 1. Analyzing the current manpower inventory 2. Making future manpower forecasts 3. Developing employment program 4. Design training program STEPS IN MANPOWER PLANNING 1. Analyzing the current manpower inventory- Before a manager makes forecast of future manpower, the current manpower status has to be analyzed. For this the following things have to be noted- • Type of organization • Number of departments • Number and quantity of such departments • Employees in these work units Once these factors are registered by a manager, he goes for the future forecasting. 2. Making future manpower forecasts- Once the factors affecting the future manpower forecasts are known, planning can be done for the future manpower requirements in several work units. The Manpower forecasting techniques commonly employed by the organizations are as follows: a. Expert Forecasts: This includes informal decisions, formal expert surveys and Delphi technique. Page 17
  • 18.
    b. Trend Analysis:Manpower needs can be projected through extrapolation (projecting past trends), indexation (using base year as basis), and statistical analysis (central tendency measure). c. Work Load Analysis: It is dependent upon the nature of work load in a department, in a branch or in a division. d. Work Force Analysis: Whenever production and time period has to be analysed, due allowances have to be made for getting net manpower requirements. e. Other methods: Several Mathematical models, with the aid of computers are used to forecast manpower needs, like budget and planning analysis, regression, new venture analysis. 3. Developing employment program- Once the current inventory is compared with future forecasts, the employment program can be framed and developed accordingly, which will include recruitment, selection procedures and placement plans. 4. Design training program - These will be based upon extent of diversification, expansion plans, development program ,etc. Training program depend upon the extent of improvement in technology and advancement to take place. It is also done to improve upon the skills, capabilities, knowledge of the workers. IMPORTANCE OF MANPOWER PLANNING 1. Key to managerial functions- The four managerial functions, i.e., planning, organizing, directing and controlling are based upon the manpower. Human resources help in the implementation of all these managerial activities. Therefore, staffing becomes a key to all managerial functions. 2. Efficient utilization- Efficient management of personnels becomes an important function in the industrialization world of today. Setting of large scale enterprises require management of large scale manpower. It can be effectively done through staffing function. 3. Motivation- Staffing function not only includes putting right men on right job, but it also comprises of motivational programmes, i.e., incentive plans to be framed for further participation and employment of employees in a concern. Therefore, all types of incentive plans becomes an integral part of staffing function. Page 18
  • 19.
    4. Better human relations- A concern can stabilize itself if human relations develop and are strong. Human relations become strong trough effective control, clear communication, effective supervision and leadership in a concern. Staffing function also looks after training and development of the work force which leads to co-operation and better human relations. 5. Higher productivity- Productivity level increases when resources are utilized in best possible manner. Higher productivity is a result of minimum wastage of time, money, efforts and energies. This is possible through the staffing and its related activities (Performance appraisal, training and development, remuneration) NEED OF MANPOWER PLANNING Manpower Planning is a two-phased process because manpower planning not only analyses the current human resources but also makes manpower forecasts and thereby draw employment programmes. Manpower Planning is advantageous to firm in following manner: 1. Shortages and surpluses can be identified so that quick action can be taken wherever required. 2. All the recruitment and selection programmes are based on manpower planning. 3. It also helps to reduce the labour cost as excess staff can be identified and thereby overstaffing can be avoided. 4. It also helps to identify the available talents in a concern and accordingly training program can be chalked out to develop those talents. 5. It helps in growth and diversification of business. Through manpower planning, human resources can be readily available and they can be utilized in best manner. 6. It helps the organization to realize the importance of manpower management which ultimately helps in the stability of a concern. Page 19
  • 20.
    TYPES OF RECRUITMENT: 1.INTERNAL RECRUITMENT - is a recruitment which takes place within the concern or organization. Internal sources of recruitment are readily available to an organization. Internal sources are primarily three - Transfers, promotions and Re-employment of ex-employees. Re- employment of ex-employees is one of the internal sources of recruitment in which employees can be invited and appointed to fill vacancies in the concern. There are situations when ex- employees provide unsolicited applications also. Internal recruitment may lead to increase in employee‟s productivity as their motivation level increases. It also saves time, money and efforts. But a drawback of internal recruitment is that it refrains the organization from new blood. Also, not all the manpower requirements can be met through internal recruitment. Hiring from outside has to be done. Internal sources are primarily 3 types a. Transfers b. Promotions (through Internal Job Postings) and c. Re-employment of ex-employees - Re-employment of ex-employees is one of the internal sources of recruitment in which employees can be invited and appointed to fill vacancies in the concern. There are situations when ex-employees provide unsolicited applications also. 2. EXTERNAL RECRUITMENT - External sources of recruitment have to be solicited from outside the organization. External sources are external to a concern. But it involves lot of time and money. The external sources of recruitment include - Employment at factory gate, advertisements, employment exchanges, employment agencies, educational institutes, labor contractors, recommendations etc. a. Employment at Factory Level - This a source of external recruitment in which the applications for vacancies are presented on bulletin boards outside the Factory or at the Gate. This kind of recruitment is applicable generally where factory workers are to be appointed. There are people who keep on soliciting jobs from one place to another. These applicants are called as unsolicited applicants. These types of workers apply on their own for their job. For this kind of recruitment workers have a tendency to shift from one factory to another and therefore they are called as “badli” workers. b. Advertisement - It is an external source which has got an important place in recruitment procedure. The biggest advantage of advertisement is that it covers a wide area of market and scattered applicants can get information from advertisements. Medium used is Newspapers and Television. c. Employment Exchanges - There are certain Employment exchanges which are run by government. Most of the government undertakings and concerns employ people through such Page 20
  • 21.
    exchanges. Now-a-days recruitmentin government agencies has become compulsory through employment exchange. d. Employment Agencies - There are certain professional organizations which look towards recruitment and employment of people, i.e. these private agencies run by private individuals supply required manpower to needy concerns. e. Educational Institutions - There are certain professional Institutions which serves as an external source for recruiting fresh graduates from these institutes. This kind of recruitment done through such educational institutions is called as Campus Recruitment. They have special recruitment cells which help in providing jobs to fresh candidates. f. Recommendations - There are certain people who have experience in a particular area. They enjoy goodwill and a stand in the company. There are certain vacancies which are filled by recommendations of such people. The biggest drawback of this source is that the company has to rely totally on such people which can later on prove to be inefficient. g. Labour Contractors - These are the specialist people who supply manpower to the Factory or Manufacturing plants. Through these contractors, workers are appointed on contract basis, i.e. for a particular time period. Under conditions when these contractors leave the organization, such people who are appointed have to also leave the concern. Employee Selection is the process of putting right men on right job. It is a procedure of matching organizational requirements with the skills and qualifications of people. Effective selection can be done only when there is effective matching. By selecting best candidate for the required job, the organization will get quality performance of employees. Moreover, organization will face less of absenteeism and employee turnover problems. By selecting right candidate for the required job, organization will also save time and money. Proper screening of candidates takes place during selection procedure. All the potential candidates who apply for the given job are tested. But selection must be differentiated from recruitment, though these are two phases of employment process. Recruitment is considered to be a positive process as it motivates more of candidates to apply for the job. It creates a pool of applicants. It is just sourcing of data. While selection is a negative process as the inappropriate candidates are rejected here. Recruitment precedes selection in staffing process. Selection involves choosing the best candidate with best abilities, skills and knowledge for the required job. The Employee selection Process takes place in following order- 1. Preliminary Interviews- It is used to eliminate those candidates who do not meet the minimum eligibility criteria laid down by the organization. The skills, academic and family Page 21
  • 22.
    background, competencies andinterests of the candidate are examined during preliminary interview. Preliminary interviews are less formalized and planned than the final interviews. The candidates are given a brief up about the company and the job profile; and it is also examined how much the candidate knows about the company. Preliminary interviews are also called screening interviews. 2. Application blanks- The candidates who clear the preliminary interview are required to fill application blank. It contains data record of the candidates such as details about age, qualifications, reason for leaving previous job, experience, etc. 3. Written Tests- Various written tests conducted during selection procedure are aptitude test, intelligence test, reasoning test, personality test, etc. These tests are used to objectively assess the potential candidate. They should not be biased. 4. Employment Interviews- It is a one to one interaction between the interviewer and the potential candidate. It is used to find whether the candidate is best suited for the required job or not. But such interviews consume time and money both. Moreover the competencies of the candidate cannot be judged. Such interviews may be biased at times. Such interviews should be conducted properly. No distractions should be there in room. There should be an honest communication between candidate and interviewer. 5. Medical examination- Medical tests are conducted to ensure physical fitness of the potential employee. It will decrease chances of employee absenteeism. 6. Appointment Letter- A reference check is made about the candidate selected and then finally he is appointed by giving a formal appointment letter. Training of employees takes place after orientation takes place. Training is the process of enhancing the skills, capabilities and knowledge of employees for doing a particular job. Training process moulds the thinking of employees and leads to quality performance of employees. It is continuous and never ending in nature. IMPORTANCE OF TRAINING Training is crucial for organizational development and success. It is fruitful to both employers and employees of an organization. An employee will become more efficient and productive if he is trained well. Training is given on four basic grounds: 1. New candidates who join an organization are given training. This training familiarize them with the organizational mission, vision, rules and regulations and the working conditions. 2. The existing employees are trained to refresh and enhance their knowledge. Page 22
  • 23.
    3. If any updations and amendments take place in technology, training is given to cope up with those changes. For instance, purchasing a new equipment, changes in technique of production, computer implantment. The employees are trained about use of new equipments and work methods. 4. When promotion and career growth becomes important. Training is given so that employees are prepared to share the responsibilities of the higher level job. The benefits of training can be summed up as: 1. Improves morale of employees- Training helps the employee to get job security and job satisfaction. The more satisfied the employee is and the greater is his morale, the more he will contribute to organizational success and the lesser will be employee absenteeism and turnover. 2. Less supervision- A well trained employee will be well acquainted with the job and will need less of supervision. Thus, there will be less wastage of time and efforts. 3. Fewer accidents- Errors are likely to occur if the employees lack knowledge and skills required for doing a particular job. The more trained an employee is, the less are the chances of committing accidents in job and the more proficient the employee becomes. 4. Chances of promotion- Employees acquire skills and efficiency during training. They become more eligible for promotion. They become an asset for the organization. 5. Increased productivity- Training improves efficiency and productivity of employees. Well trained employees show both quantity and quality performance. There is less wastage of time, money and resources if employees are properly trained. WAYS/METHODS OF TRAINING Training is generally imparted in two ways: On the job training- On the job training methods are those which are given to the employees within the everyday working of a concern. It is a simple and cost-effective training method. The in-proficient as well as semi- proficient employees can be well trained by using such training method. The employees are trained in actual working scenario. The motto of such training is “learning by doing.” Instances of such on-job training methods are job-rotation, coaching, temporary promotions, etc. Off the job training- Off the job training methods are those in which training is provided away from the actual working condition. It is generally used in case of new employees. Instances of off the job training methods are workshops, seminars, conferences, etc. Such method is costly and is effective if and only if large number of employees have to be trained within a short time period. Off the job training is also called as vestibule training, i.e., the employees are trained in Page 23
  • 24.
    a separate area(may be a hall, entrance, reception area, etc. known as a vestibule) where the actual working conditions are duplicated Training methods pertain to the types of training that can be provided to employees to sharpen their existing skills and learn new skills. The skills that they learn can be technical or soft skills and for all categories of skills, some training methods are suggested here. The training methods can range from onsite classroom based ones, training at the office during which employees might or not might check their work, experiential training methods which are conducted in resorts and other places where there is room for experiential learning. Training methods include many types of training tools and techniques and we shall discuss some of the commonly employed tools and techniques. For instance, it is common for trainers to use a variety of tools like visual and audio aids, study material, props and other enactment of scene based material and finally, the experiential tools that include sports and exercise equipment. If we take the first aspect of the different training methods that are location based, we would infer from the explanation that these training methods include the specific location based ones and would range from classroom training done at the trainers‟ location to the ones done on the office premises. Further, the experiential training methods can include use of resorts and other nature based locations so that employees can get the experience of learning through practice or the act itself rather than through study material. It needs to be remembered that the trainings conducted in the office premises often involve employees taking breaks to check their work and hence might not be ideal from the point of view of the organizations. However, provision can be done to locate the training rooms away from the main buildings so that employees can be trained in a relaxed manner. For instance, Infosys has training centres that are exclusively built for training and these centres give the employees enough scope and time for learning new skills. The next aspect of the training methods includes the use of visual and audio aids, study material, props and equipment. Depending on the kind of training that is being imparted, there can be a mechanism to use the appropriate tools and techniques based on the needs of the trainers and the trainees. The use of the training material often indicates the thoroughness of the training program and the amount of work that the trainers have put in to make the training successful. Of course, if the training material is good, it also means that the employees would benefit from the scope and depth of the material though they need to invest time and energy as well. Finally, the bottom line for any training to be successful is the synergy between the trainers and the trainees and this is where the HRD function can act as a facilitator for effective trainings and ensure that the trainers and trainees bond together and benefit in a mutual process of Page 24
  • 25.
    understanding and learning.In conclusion, there are various ways to approach trainings and some of the methods discussed above would be good starting points for follow up action and partnership between the training agencies and the organizations. AREAS OF PROGRAMMES AT HRD CENTRE: o NON EXECUTIVE  ENHANCNG ENGINEERING SKILLS (MECHANICAL)  ENHANCNG ENGINEERING SKILLS (ELETRICAL)  MUTISKILL  HYDRAULICS AND PUMP  ELECTRONCS AND PLC  COMPUTER  UNIT TRAINING o EXECUTIVE  COMPUTER  MANAGERIAL GENERAL MANAGEMENT  MANAGERIAL FUNCTION Page 25
  • 26.
    MARKETING DEPARTMENT Marketing isdefined as the process of determining the needs and wants of consumers and being able to deliver products that satisfy those needs and wants. Marketing includes all of the activities necessary to move a product from the producer to the consumer. Think of marketing as a bridge From the producer to the consumer. Marketing starts with market research, learning process in which marketers get to know everything they can about the needs and wants of consumers, and it ends when somebody buys something. Many companies feel that services provided to customers after the purchase also are an important part of marketing. All of these Enterprises -- production, advertising, transportation, processing, packaging, and selling -- are included in the marketing process. THE NINE FUNCTIONS OF MARKETING In order for the marketing bridge to work correctly -- providing consumers with opportunities to purchase the products and services they need -- the marketing process must accomplish nine important functions. The functions are: BUYING - people have the opportunity to buy products that they want. SELLING - producers function within a free market to sell products to consumers. FINANCING - banks and other financial institutions provide money for the production and marketing of products. STORAGE - products must be stored and protected until they are needed. This function is especially important for perishable products such as fruits and vegetables. TRANSPORTATION - products must be physically relocated to the locations where consumers can buy them. This is a very important function. Transportation includes rail road, ship, airplane, truck, and telecommunications for non-tangible products such as market information. PROCESSING - processing involves turning a raw product, like wheat, into something Page 26
  • 27.
    The consumer canuse -- for example, bread. RISK-TAKING - insurance companies provide coverage to protect producers and marketers from loss due to fire, theft, or natural disasters. MARKET INFORMATION - information from around the world about market conditions, weather, price movements, and political changes, can affect the marketing process. Market information is provided by all forms of telecommunication, such as television, the internet, and phone. GRADING AND STANDARDIZING - Many products are graded in order to conform to previously determined standards of quality. For example, when you purchase US No. 1 Potatoes, you know you are buying the best potatoes on the market. THE FOUR UTILITIES OF MARKETING The marketing process must also add "utility" to the products consumers want. Utility is the use or satisfaction a person gets from a product. If you purchase a chain saw you anticipate that you will receive a certain amount of utility from it. You will be able to use the saw to cut fire wood, prune trees, and take care of a variety of jobs around your home. There are four types of utility. FORM UTILITY - a product must be processed into a form that the customer wants or needs. For example, wheat is processed into bread, trees are processed into lumber, and potatoes are processed into French fries. If you ordered French fries with your lunch and the waiter brought you a raw potato, you probably wouldn't be too happy. PLACE UTILITY - place utility involves transporting products to the location where consumers can buy them. If you live in Alaska, you certainly wouldn't want to have to drive to California to buy oranges. Thanks to our modern transportation systems you don't have to; you simply drive to the local grocery store and oranges are there ready to add to your shopping cart -- place utility. POSSESSION UTILITY - possession utility establishes legal ownership of a product. When you purchase something you normally receive a receipt; this provides legal ownership and the right to use the product. Some products, computer software, for example, also provide a user license. A license of this kind gives you the right to use the product within certain guidelines. Stocks prove that you own part of a company .This is an example of Possession Utility. Page 27
  • 28.
    TIME UTILITY -this could be described as being in the right place at the right time when a customer is ready to purchase a product. Creating and keeping customers means having products available for when they want them, and often this requires some type of storage facility. Wheat is one example of a commodity that must be stored after it is harvested. It is stored in silos until processors are ready to convert it into food products such as bread or cereals. MARKETING STRATEGIES OF STEEL INDUSTRY Global marketing strategies are not standard product and market strategies that assume the world to be a single. Global marketing strategies are also not about global presence or about large companies. A company can very well operate in as many as countries, but if what it does in one country has no meaning for what it does in the other country, it is no different from the domestic companies. To qualify as pursuing global strategy a company needs to be able to demonstrate two things: 1) It should be able to contest in any market it chooses to compete in. 2) It should be able to bring its entire resources to bear on any competitive situation it finds itself in, regardless of where that might be. The following are the main attributes of global marketing strategy: 1) Standard products and marketing mix: There is a need to aim for a standard core in the product and to limit marketing adaptation to these aims. The more integrated the companies become economically, the less latitude there is any way for things such as price discrimination and channel selection. The same applies to situations where buyers themselves are global and expect similar products and terms on a worldwide basis. 2) Sourcing assets and not just products: Sourcing products and components internationally based has long been a feature of international business. However this attribute implies that global marketing strategies are much about asset deployment for market access purpose as they are about asset accumulation abroad. 3) Market access in line with breakeven: In order to be competent in the global market a company need not be the biggest in its kind. Instead it should be able to generate the volume of sales the required infrastructure demands. 4) Contesting assets: The other feature of global companies is it can neutralize the assets and competencies of its competitors. For example, if a competitor is forced to switch from a Page 28
  • 29.
    low-cost to high-costfactory, it too can do so. Similarly if a competitor gains access to a new technology, it can do the same. 5) Functions have a global orientation: The competition at the global market level is not just at the product or service level. It is also about building and maintain multinational infrastructure. The above five attributes taken together operational the global strategy. Conclusion: Global marketing strategies is gaining importance as more and more business organizations are looking to compete in the global market MARKETING OF JSPL Jindal Steel And Power Limited JSPL is India‟s leading steel maker presents the world of steel..Backed by over five decades of experience of producing quality steel and creating the sinews of a modern India. JSPL s five integrated steel plants (ISPs) produce the widest range of steel products that fulfil diverse needs of our customers. JSPL works closely with its customers understanding their needs and matching it with the right product. In case, you do not find your specific product here (by the laws of probability chances do exist, despite the fact that JSPL has the largest and widest products range in steel), and need something exclusive (in terms of quality, size, etc.) still, JSPL is the answer. For JSPLs dedicated R&D Centre, one of the most modern and largest in the country, it is an everyday affair to churn out customized products and JSPLs 5 ISPs give shape to their research capabilities. All this, to make every customer of JSPL steel feel special, and satisfied. JSPLs ongoing up-gradation and expansion program will further enhance our capability to add to JSPLs product basket and provide more special quality steel for niche industry needs. Page 29
  • 30.
    ENLISTING NEW CUSTOMERINTO THE ORGANIZATION DETAILS REQUIRED FROM NEW CUSTOMERS New customers desirous of starting import of Mild steel products of JSPL on sustained basis are requested to send the following details/documents for enlistment. 1. Customer profile (Details of the customer / Firm) who will establish the Letter of Credit. 2. Name, Address, Telephone & Fax number, e-mail of the Contact person overseas and the same of the representative in India (if any). 3. Last two years balance sheet of the company desirous of doing business with JSPL. 4. Name, address of the Bank through which the Letter of Credit will be established. 5. A certificate from the banker about business dealing with the customer Page 30
  • 31.
    MATERIALS DEPARTMENT STORE KEEPING: Storeis an area of Materials Management Department and has an interface with many user departments in its daily operations. The other areas being purchase, Inspection, PIVD, SRG etc,. The basic purpose served by it, is the provision of uninterrupted service to production departments. Store is the finishing area where materials management activities come to an end. The indenting of materials, processing of indents, finalizing indents, procurement of materials with necessary formalities, inspection of materials and finally the account and custody of materials are covered under the materials management activities. Arrival of materials at destinations, unloading them, arranging for their inspection (wherever necessary) and finally taking account action together with custody , with the objective of efficiently and economically providing the right material at the right time whenever required in the right condition to all user departments are the Storekeeping functions. Receiving the materials either at stores location or at users site, acceptance of the right material at the right time are to be carefully carried out, so as to see that the supplier does not suffer from inordinate delay both in unloading and account action. Similarly the internal customer i.e., the user departments do not find any difficulty for drawl of materials in time. The storekeeper in a store plays a vital role in all the above activities depending upon the duty allotted to him by his controlling officers. The concern storekeepers looking after the various sections of the stores are the key functionaries around which all the Storekeeping activities revolve. The Storekeeper has to prepare a well co-ordinated plan and accordingly co-ordinate with all the necessary agencies such as; the supplier, transporter, purchase, inspection, FM(M) and the laboratory (if necessary) and the user departments. All the agencies do have their role to play as and when approached by the store. Page 31
  • 32.
    Storekeeping job thoughsounds much simple are an intricate job. The Storekeeper has to foresee, visualize the shape of things to come in the days ahead wherein he has to function within limited resources. Accordingly he decides and plans how to keep the materials where to keep them safely so that they can be safely and securely issued to the user without any difficulty. MATERIALS MANAGEMENT The Stores Department is a part and parcel of the Materials Management Department, which is functioning under the overall control of the Executive Director, Materials Management. The Stores Department is headed by Deputy General Manager I/C (MM), Inspection & Stock Control, who is assisted by DGM.(MM) Stores Administration, DGM.(Stock Control) and other executives of Stores department. There are all together 21executives working in stores Department as on date. There are Five Main Stores and Five Sub-Stores in Material Management Department of Rourkela Steel Plant. 1. CENTRAL STORES 2. MODERNIZATION STORES 3. REFRACTORY STORES 4. PLANT STORES – II 5. CSM STORES 6. SUB –STORES:  BLAST FURNACE SUB-STORES  COLD ROLLING MILL SUB-STORES  HOT STRIP MILL SUB-STORES  SINTERING PLANT SUB-STORES  TRAFFIC SUB-STORES Page 32
  • 33.
    As we knowthat Store keeping function is an inseparable part to any organization, whether industrial or service oriented, public or private, small or large. Even though store keeping does not add any value to the product in normal sense, it is an essential function and just cannot wished away. The Storekeeping activities in Rourkela Steel Plant, are carried out according to the Stores Procedures, Standard Operating Practices and Stores Manual. These activities are discussed in detail in the preceding chapters. MATERIAL RECEIPT & ACCOUNTING Various material required in the plant are received various sources from outside which are verified and accounted for in the Stores. Materials are received from various sources through various modes of transportation. The major mode of transportation in our plant is receipt through Rail and Road. Other than this the materials are received through courier, registered post or by hand also. 1.0 RECEIPT: The receipt function is the last step in the Purchasing activity and the first link in the Stores Function. This deals with the function of Receiving and physically handling delivered materials and verifying that the delivery corresponds exactly as to the nature and quantity as per specified in Purchase Order. The Storekeeping functions starts with the arrival of Consignments / Materials at the Material Gate i.e. the Traffic Gate of JSPL. All incoming materials to the plant are physically checked for number of Packets by CISF. The Stores representative i.e. the Storekeeper checks the validity of the delivery after checking an on-line entry is made regarding A/T No., Challan No., Consignment Note (C/N), Type of vehicle, Vehicle No. etc. in the Integrated Material Management System(IMMS) and the truck movement permit is generated. Entry of materials at Traffic Gate is permitted between 8:30 am to 12:30 pm and 3:30 pm to 4:30 pm. The GARN Lead Time calculation is started from the time of Gate entry. On reaching the materials at Stores, the representative of the Supplier / Transporter reports the Stores Gate, where the documents are checked and entered into a register manually. The Central Store Gate is computerised, where Data is picked-up from Traffic Gate entry. On giving the A/T No. only entry time and receiving Bay location is fed in the system and correction / updation, if any, is also done here. Page 33
  • 34.
    1.1 WEIGHMENT: Weight of minor raw materials such as Tin Ingot, Copper cathode, Nickel Lead etc., are weighed in Dial Scale/Electronic scale of metal bay in piles. Certain other raw materials such as Aluminium ingot, Zinc, Oil and Lubricants, Graphite, Electrode, Casting Powder (Indigenous, Carbon dioxide, are weighed in RSP road weigh bridge controlled by PPC. After the CISF gate entry of trucks/handcarts, each consignment is weighed either at PPC road weigh bridge or at stores Dial/Electronic scale as per the SOP with a Weighment memo prepared by the concerned store keeper and counter signed by the concerned officer. The Weighment memo depicts date, name of the material, source of supply, A/T No. , C/N no., challan no., & date and space for recording Gross weight, Tare weight, sign of the weigh bridge operator and witness wherever necessary. The Gross weight is taken first and after the unloading the tare weight is taken. Out of 3 copies, the 1st is handed over to the stores, the 2nd retained by the weighbridge and the 3rd to the supplier/transporter. 1.2 UNLOADING: Unloading of materials from trucks or hand carts or by hand is with reference to A/T clause. It is either unloaded by the supplier/transporter or the stores. Depending upon the size/dimension it is either unloaded manually or with the help of equipment. All the main Stores have gates functioning with store keeping staff and attendants. The gate asks for the documents accompanying the truck/hand carts. The documents are sent for verification to the stores officer in charge of receipt and if it is found that the matter belongs to that store and the documents ok, then the truck/hand cart is allowed inside for unloading with necessary entries at the gate. Of course the trucks/hand carts carried materials required to be weighed at the PPC road weighbridge are sent to Weighment and after gross weight is taken at the weighbridge, the truck/handcart is allowed for unloading. Before unloading, the seal (if any), the condition of the containers are checked by the storekeeper in presence of the supplier/transporter‟s representative, if they are ok, if it is not ok either the seal is Page 34
  • 35.
    broken/missing, containers damaged,then suitable remarks are made on the challan/consignment note with the supplier‟s/transporter representative‟s signature. The concerned Bay store keeper (s) decides as to how and where the materials are to be unloaded. If heavy consignment, then EOT crane or forklift has to be put on the job of unloading. The storekeeper has to have a logistic approach while unloading keeping the accessibility, safe up-keep of the material, self life in case of chemicals, susceptibility of being exposed to nature etc,. 1.3 DAY BOOKING : After the materials are unloaded at the specified Bay/Yard, Day Booking is immediately taken up. In case of weighable material it is only after tare weight is taken, Day booking taken place. Day booking however in all cases is to be done within 24 hours. The details about the consignments are fed in the IMMS on line. The A/T no., the document no., & date, the challan no., & date, no. of packages, quantity CENVAT details, Way Bill no. & date are also entered online. Then automatically the Daybook is allowed in the system and the Day book no. is allotted. The Daybook no. & date is recorded in the consignment note/ challan/ invoice/Waybill etc. At the end of the day the printout of the entire Daybooks raised in a section is taken up and put in the register. The D-3 declaration enclosing the EDGP and Waybills (triplicate copies) are sent to F & A (stores bill) and Purchase respectively. However incase of large consignment and materials having the storage facility at site, are sent directly to user Departments for unloading only after raising of Day Book and Direct Delivery Note (DDN) at Stores. 1.4 INSPECTION: Inspection is a skilled operation and is done by specialised / trained personnel, proper testing facilities and methods. The purpose of inspection is to ensure that that the materials delivered are the same as those ordered, of the right quantity–dimensions, chemical characteristics etc., and are in proper condition. The Inspection is of two types like: - 1) Inspection at Stores and 2) Pre-dispatch Inspection. IN Inspection at Stores; the concerned Storekeeper prepares a check report manually and put-up physically to Inspection Department. Inspection Department deputes an Inspecting Officer, who conducts the inspection after checking the documents required by A/T goes through TC / GC /MTC etc, Page 35
  • 36.
    and checks thematerial delivered and they are according to the A/T stipulation then the case is passed with the remarks “Inspected and Accepted” or else the case is rejected with qualifying remarks. In Pre-dispatch Inspection; when the consignment arrives with pre – dispatch I/C (inspection certificate) along with other documents, the concerned store-keeper checks dispatched from the loading points with 45 days of issue of I/C and whether the material is having the suppliers identification the necessary tag, seal, impression or embossment as mentioned in the I/C. In other words, the material is correlated with the I/C, challan etc., with regard to the quantity in A/T requirement/ supplier‟s identification/inspection‟s mark of certification then it is treated as OK and GARN is raised accepting the material or else is rejected with reasons giving in the remarks column of the GARN. Sometimes, joint inspection with user department is also conducted as per A/T terms, where lab test is required. Sample is drawn by inspection in presence of Concerned Storekeeper for testing at Research & Control Laboratory (RCL). After the test report, materials at inspection, acceptance or rejection GARN is raised. For Refractory items, where accounting is made in set, Day-booking is made after completion of supply against sets. Since set consists of large volume of materials, supplies are made in number of consignments in duration of some days. Refractory Stores maintains manual register for each such item separately. All Invoice No., Challan No. with dates, items as per BOM with quantity, A/T no., supplier are entered in the register. After completion of the supplies of all components of set of material, the supplier gives the completion certificate (or otherwise) stores raises Day Booking and enters line items against all such multiple invoice (one invoice with one or more items in one line entry) & one Daybook is raised for multiple invoices. In all cases, where Way-bill requirement exists, stores checks the second copy of Way-bill and sends back to purchase through system generated memo. Submission of D-3 forms for Excisable goods: each stores submits declaration of D-3 forms DFT copies of EDGP to Finance and Accounts Excise section, after Day-booking. Modernization Stores receives Capital, AMR & Revenue items. AMR & Revenue items are accounted and issued as per normal Stores Procedure against Stores Issue Note. In case of Project items against a single Catalogue, multiple items are received in phases, as per BOM. The single supply continues to a longer period till the project is completed. Inspection also carried out challan wise may be at Firms premises or at Stores by Inspection. If required by the Project, material issued on manual Page 36
  • 37.
    delivery note, ifit is inspected and accepted material before raising GARN but finally GARN is raised after getting Supply Completion Report from supplier endorsed by Indentor.In these cases, Daybook is done in Computer (not IMMS), which is developed by C&IT for tracking the material. Day Books are done in different series in Day Book Tracking System. Finally a single Day Booking is done in IMMS system, generated against all the consignments and GARN is raised. In the GARN, in remarks column, all the tracking Day Books are mentioned. For Capital items Manual A/T, where no catalogue numbers are in A/T, manual Day Book is done against receipt of materials and material issued on manual delivery note. No Garn is raised. Payment is made against receipted challan and commissioning. The CSM Store receives materials like Cement, Pipes, Structural materials. Refractory store receives refractory materials like, Bricks, Lining materials etc., in case of refractory stores, materials are issued multiple items against single stores requisition and the entire process of multiple issues is manual. After all issues are complete, Stores Issue Note is generated and Bin Card is posted. Plant Stores–II (PS-II) mostly handles Chemicals, Ferro alloys, Sulphur etc., PS II has two bays and in case of materials received in wagons it is directly send to the user department with DDN. In PS II sieving analysis is done for the purpose of inspection. Besides the 5 main Stores, materials are received in 2 Sub – Stores (S/S). The SP – I S/S receives safety shoes. Traffic S/S receives diesel directly but GARN is accounted in PS-II. The receiving activities take place at Oil Godown, which is under the Central Stores for oil and lubricants under Consumer Operated Lube Depot (COLD) agreement. Which belongs to IOC, and not in RSP inventory. It is only after the drawl of material by the user on line, payment is released to the supplier i.e. IOC. This is a model set up years ago with the help of IOC as an inventory reduction measure. Other than IOC items the V section of C/S takes the account action of the rest oils and the custody remains with Oil Godown. STORAGE , MATERIAL ISSUE AND ACCOUNTING The materials received from various sources need to be stored properly in Stores for ensuring the proper upkeep of material till its use, to ensure security and safety of the material, the ease of retrieval and handling. Material required for use in various departments are collected from Stores against Stores Issue Note (Requisition Slip ). The various aspects of storage and material issue are discussed below : 1.0 CUSTODY: Page 37
  • 38.
    Every custody sectionof stores has an earmarked area within its bay for receiving all incoming consignments. Hence, as soon as materials are brought first kept in this place. The custodian in charge, checks the goods & identify the items with a tag and further follow up action taken for shifting the materials to its respective locations. While checking the following practices are followed. a) Check the description of the supplied material given in the documents with physical number of goods received as delivery. b) Checking should carry on to ensure where damage or breakage is there. c) If earlier stock in the Bin Card is there, the materials are to checked and matched with the existing one. d) To possibility the materials are to be stored in the original packing as given by the supplier. e) The seals of the reputed firms need not be un-sealed since it runs a risk the contents of the material, be damaged or deteriorated. f) Mention the location on the Bin-Card and all relevant documents. 1.1 POSTING OF GARN: Custody scrutinizes the GARN as per physical receipt of material, i.e. tally description, quantity, Cat. No., CTC Code, Unit code, match with existing Stock etc and in case of discrepancy, issue is reverted to Inspection, Indentor for review/justification and also with physical Bin Card and then posts the GARN. On posting GARN, it updates Inventory Master & A/T quantity, A/T status. Material can be drawn / issued only after GARN posting is complete. 1.2 LOCATION: The location of the stock of each item is maintained in the Bin Card; so that any item can easily be traced, located for transaction like receipt & issue. There are two ways of maintaining item locations: Fixed location & Random locations. In the fixed location system materials are stored in a specific place every time it is received. In Random location Page 38
  • 39.
    system, items arestored in different locations based on the availability of space and corresponding location reference is given on the Bin Card against the corresponding stock. 1.3 ISSUE: The term issue implies the normal supply of materials from Stores to various user departments. Efficient issue of materials from the Stores is the benchmark to judge the performance of store keeping functions. Most user departments judge the effectiveness of Stores by the service level of Stores. The issue of material by Custody is as per requisition, raised on line in Integrated Material Management System (IMMS) by the user departments. The requisition can be of Capital Items and Revenue Items. In case of capital items, Finance online clears the Requisition slips. Finance checks ACO code, A/T no. Also for Cement & structural issued for any project, Finance clears SIN, before issue of Materials. In case of revenue i.e. centrally procured items & Stock Control items, the requisition is cleared online by various agencies. After release the Requisition Slip is printed by the respective Indenter /user. Concerned Department releases quantity for items indented by them (For other Dept‟s stock, clearance from owner Dept is required), Stock Control for Stock Control items including mechanical and electrical spares, which were procured earlier by CEC. Safety Dept. for Safety Items, PPC for MRM items, LUHP for Hydraulic Hoses & Lubes. System checks consumption budget availability before raising requisition. On availability of budget the requisitions can be printed by Indenter /User and get the hardcopy signed by an authorized signatory of that department. Each requisition slip is valid for eight days from the date of generation for physical drawl. More than one requisition can be generated & released even if total release qty is more than stock availability and the stock is issued on first come first basis on submission of released requisition slip (hard copy). i.e. generation & release does not assure issue from Stores. Physical Signature cards at Central Stores are maintained by Administration for Consumables items and respective bays of Custody for Spares. Blank physical specimens Signature card are issued by Stores. At other Stores and Sub-Stores Cards are maintained by them and signature verification also is done by them. C.S. Administration does administrative job related Signature card like issue, change in name, feeding in system etc. Materials are issued after verification of signature of the person drawing the item from Stores. At C/S for consumables, Stores Admn person verifies the signature in requisition slip and for Spares the concerned Bay Store Keeper verifies the specimen signature. Custody cross checks the signatures in requisition slip and card. Page 39
  • 40.
    1.4 BIN CARD POSTING: Bin Card is the most authenticated record of the custody stores of a particular item as regards receipts, issue and balance. Hence, it is the mirror of the custodian through which the custodian can know the location, balance and the history of the material. In all stores of RSP simultaneously physical bin card as well as on-line system based Bin Card is maintained. On line Bin Card facilitates the Indentor for quick enquiry of location & balance of the particular item. The Bin Card contains the complete information of stock number, description, unit, location of the material, source of receipt, received quantity, issue quantity, document reference, name of the party from whom received or to whom issued so on. The requisition slip is sent in duplicate and the Storekeeper checks the requisition slip for completeness. As per the requisition slip the corresponding bin card to that catalog number is located. The bin card indicates the location of the material. In IMMS provision has been made to have the master data of BIN location for one entry only where as in some cases material is kept in more than one BIN location because of the volume. Material is taken out and issued to department. Requisition slip is posted and Stores Issue Note (SIN) confirming the issue is generated. This automatically up dates the Bin card in system. One Copy SIN is handed over to Dept. and the other is retained by Custody. Physical Bin cards are up dated IMMS Bin Card updates on issue of SIN. The copy of SIN is deposited at gate for taking out the material from Stores Gate. 1.5 STOCK TRANSFER VOUCHER: In case of transfer of material from Main Stores to Sub stores, a requisition is received from sub- stores, which is called Stock Transfer Voucher (STV requisition slip). STV is printed from IMMS on pre- printed stationery, which has color-coded copies for easy identification, is prepared in IMMS and the printed document is brought to stores against Requisition Slip received from Dept. For Stock Control and centrally procured items, STV is cleared on line by different agencies and material is given based on the printout with signature. In such cases, total quantity of inventory does not change since this is considered as a change in location. The location code in IMMS is changed. Inventory status changes as soon as Requisition Slip is posted. STV is posted in Bin Card manually and data base is updated automatically. 1.6 BOOK TRANSFER VOUCHER: Page 40
  • 41.
    In some cases,material from one stock number is moved to other stock number (item no.) in same/multiple location and/or category code, which is known as Book Transfer Voucher (BTV). BTV is generated online and bin card entry is made in manual as well as system. 1.7 STOCK VERIFICATION: Stock verification is done on a regular (as per schedule) basis by Stock Verification team under Finance Department. Stock Ledger is the basis for verification. Stock in the ledger is crosschecked with Physical Bin Card Stock and actual stock. The verification report is submitted to Finance & Stores for compliance in case of anomaly. In cases of physical excess / shortages in material, with clearance from Competent Authorities, Stock Adjustment Voucher (SAV) is prepared by Finance. It is a system-generated printout and affects the inventory. MIS reports can be generated to see the SAV‟s in a period of time. Based on instruction from management MM officials also conduct Stock Verification on few occasions. 1.8 STOCK RETURN NOTE (SRN): In case, the user department collects material on SI note and thereafter discovers that the material is not the intended material, then the user generates Stock Return Note (SRN) from IMMS and returns the material to Stores after re-inspection of material. If the material is used, the same cannot be returned. STV is also prepared for sending materials (Obsolete) from stores to CDY for disposal along with a memo. 1.9 CYLINDER TRACKING SYSTEM: In this system, all cylinders received from and dispatched to Suppliers are maintained. The cylinders lying at various Dept can also be tracked. Cylinders are sometimes provided by vendors based on Guarantee / Deposit. While raising SI Note by Stores, the IMMS checks with Bin card entry the inventory level and whether the requested quantity is available or not. If available then available stock will be issued. 1.10 EMERGENCY ISSUE: In case of emergency issue of material, mostly beyond normal duty hours, user from the concerned department submits a Note sheet signed by HOD and gives it to the concerned Emergency Duty Officer Page 41
  • 42.
    (EDO) in Stores.After checking the note sheet, Stores gives a written memo to CISF and concerned Store Keeper. Concerned Stores/Bay is opened in presence of CISF and material issued. Transaction is regularized later through requisition slip and Note-Sheet. 1.11 MISCELLAUNOUS; Material is issued to suppliers for Recondition items/Conversion items. (Under Inventory Category for sending the material and thereafter is received back under IC for receipt of re-conditioned material. Material is issued on loan to sister steel plants. Against dispatch note, excise clearance etc. This is done in case of urgency. 1.12. PRESERVATION; There is a time tag between the receipt & actual use of the material. Different materials get deteriorated to different extent during the storage period based on the nature of the items. So the items need to be preserved to maintained their useful life. Items need to be initially preserved to avoid deterioration during the storage and subsequently they need to be verified for any change in their conditions and corrective action need to be taken to restore the preservation. The materials which are rusted due to long storage in the open Yard are attended for preservation by the section of the custodians of stores. Before every monsoon, the materials are re- painted and stock numbers and other descriptions are again written by paint on the body of the material. In Central Store there is a provision for preservation i.e. a specific format on which concerned store keeper (s) of custody, reports the custody officer about the materials ( Bearings or Spares ) which are getting rusted or supposed to be unusable due to long storage. The custody officer make necessary arrangements i.e. cleaning or greasing of the components accordingly. In other stores the concerned store keepers look after this matter. Besides this a A/C store is there under Central Stores where rubber items such as Diaphragms, some kinds of V-Belts, PVC tapes, certain chemicals and adhesives, electronic components and computer spare etc., are stored for proper preservation. 2.0 SUB-STORES: Page 42
  • 43.
    The materials usedby multiple users are usually stored at Central Stores from where all the users get the material. Where as the material which in particular user department only can be stored in a store nearer to that department itself. Such stores are Sub-Stores in which all shop specific items and some regularly used central items are stored. Most of the major Departments get services through Sub- Stores for important and repetitive items both Consumables and Spares. Departments getting a Sub-Store facility, give Requisition Slip to Sub-Stores for Spares and for Consumables the request of requirement is made through entry in the Register kept at all Sub-Stores. In turn Sub-Stores raises STV‟s against the Requisition Slips for the collection of the material required by the department and contact the PCC for the transportation of the material. Sub- Stores representative accompanies the vehicle earmarked for a Sub-stores and collects the material from Main Stores through STV ( for stores transfer to sub stores ). Though the main functions of sub-Stores are to collect consumables and spares from main stores and issue these materials to the user departments to whom the S/S are attached to, but 2 out of the 5 S/S also performs receiving function also (as mentioned earlier). SP –I S/S receives safety shoes and issue the same to various departments of plant against requisition slips. Besides performing the S/S function, Traffic S/S receives Diesel. Diesel is supplied to RSP by Indian Oil Corporation (IOC),by the MoU between SAIL and IOC. Diesel comes in to the plant by road tankers from IOC‟s Tata Nagar Depot and unloaded at Traffic S/S. Again the same is issued to Locomotives of Traffic and Raw Material (T&RM) Department, and other production units against SI Notes (Requisition Slips). T&RM is the main consumer of Diesel. At Traffic S/S the receipt and issue of Diesel are done by following the “Diesel receipt and issue Procedure”, and GARN is accounted at PS – II. When the road tanker reports at Traffic S/S, the concerned storekeeper checks the challan, way bill, gate entry no. and the seal of the tanker and note these particulars in the Diesel Receipt Register. If found OK then the tanker is permitted to take inside of the unloading premises, where the seal of the tanker is opened and the Dip (quantity in cm) and density of the tanker is measured. If there is any shortage the same is mentioned in the challan and the signature of the driver is obtained on the challan. Diesel is stored in 4 Vertical tanks ( T.No. 1 &2 having the capacity of 113650 liters each & T No. 5 & 6 – 142000 liters, each having the total of 513000 liters. Page 43
  • 44.
    Before & afterunloading of the Diesel the store keeper on duty measures the Dip of the Tank on which Diesel to be unloaded, and mentions the details i.e. status of seal & Dip, the advised quantity, the received quantity, shortage quantity (if any) etc., on the challan and raise a STV of the received quantity and sends it to PS – II, along with the challan and Way Bill for GARN accounting and stock charging. The accounting of Diesel issue is done in every 24 hour i.e. 6 am of everyday. The Dip of all the 4 tanks were measured by the storekeeper on duty and noted in the Dip Register and converted in to quantity in liters by the help of the conversion chart provided by IOC to get the present stock quantity. The present stock is again subtracted from the previous days stock to get the previous day‟s issue quantity. Previously Diesel issue to locomotives were according to the Dip, but since May 2009 after the amendment of “Diesel Procedures”, all issues are done through flow meter i.e. the opening meter reading and the closing meter reading in every issue, quantity of issue and time is mentioned in the Diesel issue register. Hence Diesel is received in Dip and issue is done in flow meter, which are two different scale of measurement there arises a differential i.e. (+/-) quantity. This differential is noted everyday and the same is regularized at the end of the year by making SAV by the approval of the competent authority. 3.0 PLANNING CO-ORDINATION AND CONTROL: Consuming Departments generally collect their requirement of input materials from Mains Stores . Certain fast moving consumables and small spares of repetitive nature is serviced through a section under administrative control of Executive looking after Sub-Stores PCC (Planning Co-ordination and Control). The planning Co-ordination and Control deals with the transportation of materials from Main Stores to Sub-Stores/ Departments. PCC has a group of employees for co-ordination i.e. deployment of vehicle/manpower, loading/unloading the materials. PCC maintains a manual register for work allocation and allocation of vehicles for transportation. In the register all details for truck no., department/sub store, quantity etc are mentioned. In another register details for labors engaged are mentioned against each work requests. Page 44
  • 45.
    PCC manually checksthe register for day‟s requirement vis-a-vis availability of trucks/tempo and employee reported that day and allocates them the job in order of requests received keeping in mind the urgent requirement of Dept. PCC also some time provides vehicle help to Dept for collection of their material against Requisition slip. In such case manpower help is not given. Transporters submit Challan for the jobs done in a month in the first week of next month. I/C PCC verifies the job done by the transporter from their register. The job done is certified by SK I/C and Officer I/C of PCC. Transporter finally submits the consolidated Bill to Consignment Control Section of Stores for their scrutiny and clearance. The materials purchased by a concern may be classified as stock items which are taken into store and held until required or as direct deliveries to the point of consumption. The control of these materials which are stock items is known as stock control. The function of Stock Control is to obtain the maximum stock turnover consistent with the maintenance of sufficient stocks to meet all requirements. Stock turnover is the ratio which the cost of materials used per annum bears to the average stock of materials Discussion with regard to the quantity of materials stocked after may consideration such as :  The availability of capital for the provision of stocks.  The availability of storage space  The cost of storage  Risk of loss due to fall in price, deterioration, obsolescence, theft etc.  Economic order quantities  Delivery delays For effective control of materials, it is important to decide upon different materials. These levels are maximum limit or level, minimum limit or level and reorder level or ordering point. Maximum, minimum and re-order levels are not static. They are varied to suit the changing circumstances. Thus the alternation takes place if the usage of certain materials is increased or decreased. If the re-order period changes, or if, in the light of a review of capital available, it is decided that the overall inventory must be increased or decreased. Page 45
  • 46.
    Principal functions ofStock Control are : a) Indenting for AP items – Normal and Capital Repair Requirements. Rate Contract Indent requisition with Price Variation Clause is also initiated by Stock Control. b) Monitoring of materials based on requisition and managing release as per priority and consumption. c) Follow-up of Supplies as per safety stock requirements thru Purchase Inspection etc. d) Technical Scrutiny / Co-Ordinate technical scrutiny for AP items with concerned User Dept / Centralized agencies. e) Raise on line requisition for updating Specs for AP Items through SRG Inventory Management for ABC, XYZ analysis, Non Moving (5 Years), Deemed Non Moving(4 years), Potential Non Moving ( 3 years), Deemed Obsolete, Obsolete, Deemed Surplus, Surplus declaration along with all approvals, as per RSP / SAIL guideline g) MIS of Stores is co-ordinated by and maintained at Stock Control. f) Task Force activities as Convenor for several TF items. g) Stock Control is member of CPA items where RSP is CPA and also where other Plants are CPA. CPA requirements are sent to CPA Plant after clearance of ) Stock Control also represents MM during review meetings held in the Office of ED(W). h) Stock Control co-ordinates & raises SDA for materials to be sent to other Steel Plant to meet their urgent requirements. i) SC clears the Non stock Consumable indents as screening committee member on line. j) SC co-ordinates for Inventory control of stores & spares. ADDITIONAL FUNCTIONS : 1. SC is also convener of Task Force items (10 TF groups), such as Minor raw materials, conveyor belts etc where both AP and non-AP items are involved. Separate Screen for entry of Requirements etc for Task Force. 2. Stock Control is the Nodal, Convenor & Member for Indents of Consumable items. 3. Stock control focuses on maintaining Optimum Inventory for stock items, Non-stock consumable items & Task Force items , where S/C is the Convenor. Stock control focuses on “ No stock out situation” for Stock items. 4. Various review period policies like 6/12/18 months are maintained depending upon the lead time and rate of consumption. Stocks are reviewed periodically as per above policies and indents are raised as and when required. SC updates Re-order level, Max. level of items, Safety stock level for Page 46
  • 47.
    items once ina year / or as required, depending on External procurement lead time of the items & IMMS is updated. Re-order level-indenting policy is followed & indents are raised, when stock & dues-in level falls below ROL. The items of a particular class (say 011 electricals) are divided into some groups of similar nature of item, from procurement angle. (Source vendor & product code combination ). While indenting, class & group are reviewed and system indicates how much to indent on the basis of P/S & Dues-in & consumption pattern. 5. Requisition for material issue (Stores Requisition) is received online from different units / plants/ by Sub Stores (document is STV) and quantity is checked w.r.t their consumption / any reservation & released online by SC Store keepers / executives. While releasing qty., the IMMS screen is displayed for the item (stock, consumption for last 4 years etc. & other related screen are available to track pending indent & order, delivery etc.) & finally Qty. released. Qty. released may be same as requisition qty. or less as per the decision taken by SC on the basis of the information, as viewed from system. Stock control on regular basis takes out MIS reports for various items based on location, department for ABC, XYZ analysis & Non-moving analysis. Various activities like declaration of obsolete item after issue of notice to various agencies (including other Steel Plants) and departments etc and with due approvals from CA is done by SC. 6. SC is also convener of Task Force items (10 TF groups), such as Minor raw materials, conveyor belts etc where both AP and non-AP items are involved. Separate Screen for entry of Requirements etc for Task Force. INVENTORY MANAGEMENT & POLICY GUIDE LINES FOR STORE KEEPING 1.0 INVENTORY MANAGEMENT For effective Inventory Management, control is exercised on all activities of Materials Management like placement of order, receipt, storage & issues. RAISING INDENT : Indents for procurement of stores and spares raised by the authorized executive of department subject to availability of budget with the approval of competent authority of the department/office. The indents are raised in prescribed format . Past performance of vendors, who Page 47
  • 48.
    have supplied sameor similar items, should be indicated in the format while raising the indent. In case there is any deviation/complaint with reference to the quality parameters, it may be clearly specified in the indent. ORDER PLACEMENT : Wherever feasible, staggered deliveries must be resorted to, keeping in view the requirements of production units, to have proper control on Inventory. For items having limited shelf life, the delivery schedule (time as well as quantity) should take care of shelf life. (At least 80% of the shelf-life will be mandatory at the time of receipt stage). For class „A‟ & „X‟ items, the quantity to be ordered is to be reviewed again before placement of order, keeping in mind the future production plan, repair / replacement plan, stock at stores / shop floor, pending indents, dues in etc. For orders having overdue delivery, confirmation from head of user department may be obtained before giving clearance for delivery. Simplified Procedure to be formulated by CMMG and implemented for procurement of „Low Value Items‟ (for indent value up to Rs.25,000/- ) in order to avoid „Stock-Out‟ and improve „Service Level‟. Cancellation of pending Orders. In case a supplier, to whom an order has been placed, failed to supply, appropriate action may be taken as indicated in clause 18 of PP2K. Where deliveries have overshot the stipulated due date of the A/T and material has not been received, such orders will be reviewed on regular basis and if required, orders pending for 2 years and more would be cancelled after: a) Obtaining a certificate from the indenter that these materials will not be required at least for coming two years. b) Ensuring that these materials are not required to be returned, if borrowed. c) Ensuring that there are no requirement pending with Purchase Department for such materials. d) Ensuring that no advance payment is pending with the supplier. Page 48
  • 49.
    e) Taking approvalof Head of M.M. Department. • Pending orders of stores & spares of those Equipment, which are under phasing out / replacement / modification are to be identified and cancelled. • Preference is be given to products manufactured by SAIL plants / units / subsidiaries as compared to procurement from outside. RECEIPTS: For Receipt & Issue generally the Policy Guide Lines for Stores Management and Stores manuals of individual Plants / Units are to be followed) • Timely Delivery of items are be ensured. • Receipts of the materials at stores are be immediately communicate to the users. ISSUE / CONSUMPTION: • PERIODIC REVIEW OF „A‟ & „X‟ CLASS ITEMS. Each Plant / Unit shall institute a system for periodic review and monitoring of supplies and stock of all „A‟ and all ”X” class items. • DEVELOPMENT OF DATABASE FOR CAPITAL REPAIR ITEMS. M. M. Department of each Plant / Unit shall develop and maintain databases for the bills of materials, items, specification and list of vendors for the Capital Repair Jobs / High value Critical Items, and utilize the same for the purpose of timely execution of future repair jobs/procurement. Page 49
  • 50.

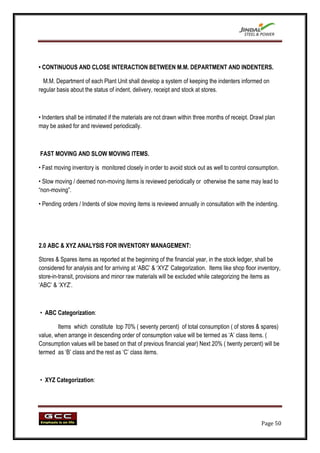

    • CONTINUOUS ANDCLOSE INTERACTION BETWEEN M.M. DEPARTMENT AND INDENTERS. M.M. Department of each Plant Unit shall develop a system of keeping the indenters informed on regular basis about the status of indent, delivery, receipt and stock at stores. • Indenters shall be intimated if the materials are not drawn within three months of receipt. Drawl plan may be asked for and reviewed periodically. FAST MOVING AND SLOW MOVING ITEMS. • Fast moving inventory is monitored closely in order to avoid stock out as well to control consumption. • Slow moving / deemed non-moving items is reviewed periodically or otherwise the same may lead to “non-moving”. • Pending orders / Indents of slow moving items is reviewed annually in consultation with the indenting. 2.0 ABC & XYZ ANALYSIS FOR INVENTORY MANAGEMENT: Stores & Spares items as reported at the beginning of the financial year, in the stock ledger, shall be considered for analysis and for arriving at „ABC‟ & „XYZ‟ Categorization. Items like shop floor inventory, store-in-transit, provisions and minor raw materials will be excluded while categorizing the items as „ABC‟ & „XYZ‟. • ABC Categorization: Items which constitute top 70% ( seventy percent) of total consumption ( of stores & spares) value, when arrange in descending order of consumption value will be termed as „A‟ class items. ( Consumption values will be based on that of previous financial year) Next 20% ( twenty percent) will be termed as „B‟ class and the rest as „C‟ class items. • XYZ Categorization: Page 50
  • 51.
    Items which constitutetop 70% (seventy percent) of total stock value (of stores & spares) holding, when arranged in the descending order of stock holding value, will be termed as „X‟ items. Next 20% (twenty percent) will be termed as „Y‟ and rest as „Z‟ category items. • Inventory levels of all “A” & all “X” category items shall be monitored rigorously preferably on monthly basis and feedback shall be given to HoMM & ED(W). • Items of „X‟ category not consumed within three months of receipt shall be reported to HOD, MM. & ED (W). • Interplant Common Database for "A" and "X" items shall be established and shall be shared by the Plants/Units. CMMG will co-ordinate and monitor this. 3.0 NORMS FOR INVENTORY HOLDING: • Norms Of stores & spares Inventory Holding shall be kept within 5 (five) months in terms of number of months consumption (for the time being). This norm to be lowered after wards. • Category wise norms (i.e. General Stores, Spares, Rolls, Refractories, Ingot Mould, Bottom Plates and others) shall be worked out by each Plant / Unit in such a manner that the overall inventory does not exceed 5 (five) months consumption. • Each Plant / Unit shall monitor the receipt and issues and will ensure that monthly cumulative average of the ratio of receipt to issue does not exceed 0.9 for all „A‟ class items. • For Automatic Procurement (AP) Items, individual Plant / Unit shall fix up Minimum Level, Safety Level, Maximum Level and Re- Order Level. The norm for inventory of AP items & consumables shall not exceed 3 months consumption. Page 51
  • 52.
    RECONDITIONING OF SPARES& EQUIPMENT: Each plant shall fix the targets for identifying spares & equipment, which can be reconditioned instead of fresh procurement. Separate allocation of funds may be made for the reconditioning activity. A centralized cell / agency in each plant under Head of Maintaince. shall be responsible for this activity. Plant to have a time based maintenance system for replacement and reconditioning of high value spares. Item flow to be traced through the computerized MM system with suitable stores valuation / pricing for the same. INSURANCE INVENTORY: a) DEFINITION OF INSURANCE INVENTORY. An Item shall be considered as an Insurance Inventory • Failure of which will result in stoppage of production process not only of the concerned shop but will also affect the preceding & succeeding shops. • Which normally does not fail but whose life expectancy is uncertain. • Which is generally a tailor made item. If it is standard item, then not readily available. • Which is identified / recommended by the Original Equipment Manufacturer (OEM) as Insurance item at the time of procurement. Insurance spares shall be declared at time of procurement of Original equipment. User department while recommending an item as Insurance, shall ensure the fulfillment of any / all the above criteria. `Declaration of insurance spares shall be done with the approval of Executive Director, (Works).Worthiness or physical condition of the insurance items may be examined every year by each user. Insurance items in store may be installed in the plant within 5 to 10 years by the user and the old one may be repaired / re-conditioned and kept in stores for future use. • PAYMENT MODULE (FINANCE) Interconnection of material management system with other available computer system should be done within the financial year 2003-04. Page 52
  • 53.
    5.0. COMPUTERISATION OFMM ACTIVITIES: The computerised system of processing the entire activities chain of Material Management and the related functions including management of documents/forms involved, are known as IMMS (Integrated Material Management System ) It generally covers the following functions • CATALOGUING • MATERIAL REQUIREMENT PLANNING • BUDGETING • INDENTING • INDENT SCREENING • PURCHASE • STORES MODULE • DISPOSAL • VENDOR RATING MODULE • PAYMENT MODULE (FINANCE) Inter-connection of material management system with other available computer system should be done within the financial year 2003-04.For providing company wide integrated information on an on-line basis to enable timely and more accurate decisions, the ERP (Enterprise Resource Planning )is under implementation at all plants. The MM/SRM ( supplier relationship module ), SCM (supply chain module ) are part of the total ERP. 6.0. SYSTEMS & PROCEDURES: Each plant should review existing systems & procedures and simplify the same keeping it in conformity with PP2K so that nil value addition/wasteful/unnecessary activities are eliminated”. This will result in reduction in costs. Illustrated area for improvements are Simplified Procedure for procurement of low value items. Page 53
  • 54.
    Online availability ofVendor Registration Forms Online availability of SAIL tender papers Online availability of Rate contracts for clearance by users. Online availability of Vendor Performance Reports. Online availability of Policy Guide lines/Procedures/Circulars/ Directives etc. 7. CEC allocates procurement Budget for AP Items during the beginning of the FY. Further for Task Force Items, Budget is provided by CEC after approval of TF recommendations by ED(W). The drawl by user Deptts. is based on the consumption budgets of those Deptts & monitored month wise.. Stock Control / Automatic Procurement Items are in the nature of bearing, safety items, furnace oils, petroleum fuels, lubricants, timber, electrical items, wire ropes, electrodes. Cables, conveyor belts, desulphurization compounds, minor raw materials - Zinc, Silico Manganese, Ferro Silicon, Aluminium, etc. Stock Control (SC) department indents through IMMS directly. Indent Approval process for AP items is within MM. Proprietary nature of requirements of stock items, are required to be approved by concerned user Deptt. HOD & concerned GM ,before approval as per DOP for Proprietary items by Stock Control.ED(W) & ED(MM) on quarterly basis for MRM & Yearly basis for other CPA items addresses the AP items requirement based on past consumption (last 5 years) and specific additional department requirements, as approved by concerned GM‟s. While Indenting , the focus is on maintaining Optimum Inventory. Capital Repair Requirement of all units is collected from CMMS System printout and after review of the CR requirement with all units, Indents are raised for CR requirement, reviewing w.r.t Present stock, pending indent & pending order of these items & consumption. Materials are followed up for procurement & getting availability of stock before CR of plant units, as per the scheduled Capital Repair shut down of respective units. Stock Control is the Nodal, Convenor & Member for Indents of Consumable items. Stock control focuses on maintaining Optimum Inventory for stock items, Non stock consumable items & Task Force items , where S/C is the Convenor. Stock control focuses on “ No stock out situation” for Stock items. Various review period policies like 6/12/18 months are maintained depending upon the lead time and rate of consumption. Stocks are reviewed periodically as per above policies and indents are raised as Page 54
  • 55.
    and when required.SC updates Re-order level, Max. level of items, Safety stock level for items once in a year / or as required, depending on External procurement lead time of the items & IMMS is updated. Re-order level indenting policy is followed & indents are raised , when stock & dues-in level falls below ROL. The items of a particular class (say 011 electricals) are divided into some groups of similar nature of item, from procurement angle. (source vendor & product code combination ). While indenting, class & group are reviewed and system indicates how much to indent on the basis of P/S & Dues-in & consumption pattern. Requisition for material issue( Stores Requisition) is received online from different units / plants/ by Sub Stores (document is STV) and quantity is checked w.r.t their consumption / any reservation & released online by SC Store keepers / executives. While releasing qty., the IMMS screen is displayed for the item (stock, consumption for last 4 years etc. & other related screen are available to track pending indent & order, delivery etc.) & finally Qty. released. Qty. released may be same as requisition qty. or less as per the decision taken by SC on the basis of the information , as viewed from system. Stock control on regular basis takes out MIS reports for various items based on location, department for ABC, XYZ analysis & Non-moving analysis. Various activities like declaration of obsolete item after issue of notice to various agencies (including other Steel Plants) and departments etc and with due approvals from CA is done by SC. INFORMATION TECHNOLOGY DEPARTMENT Rourkela Steel Plant had it‟s first rendezvous with computers in the late sixties. Since then, it has evolved into a multi-faceted IT function. Today, it addresses itself to the wide-ranging needs of its user community. Business Applications, Process Applications (Level-II), Data Communication Network, H/W Maintenance Support and the like are all a part of the IT Environment. A large state-of-art server farm caters to the varied requirements of Business Applications while widely dispersed servers are supported to meet the shop floor process needs. An extensive Fiber Optic Switched Network is in use to integrate and deliver information to the users. Common facilities for the use of employees like email, portal, etc have been provided. The IT function is now on the threshold of a watershed project – Implementation of ERP. Page 55
  • 56.
    COMPUTING RESOURCES • SUN SS20 / 712 • SUN ENTERPRISE 3000 • SUN HYPER SPARC • SUN BLADE 2000 • SUN FIRE 280R (2 Nos.) • SUN FIRE 480R (2 Nos.) • SUN 3510 FIBER STORAGE • SUN ENTERPRISE 3000 • SUN FIRE V440 (2 Nos.) • IBM x-236 XEON SERVER (5 Nos.) • CISCO PIX 535E FIREWALL • CISCO 4210 IPS • WINDOWS 2000 SERVER for e - Procurement Data Exchange JSPL NETWORK The life line of JPL Computerisation is the 100Mbps / 1Gbps Fibre Optics Network. It is of 80 kms length and runs both inside the plant premises as well as Township. The remote areas or the areas where network is not yet laid run on modems. Overall JSPL network includes 1300 + nodes. The entire server farm is protected by using CISCO PIX 535E Firewall and CISCO 4210 Intrusion Protection System. JSPL network is based on Three fold Hierarchy of switches and implements the VLAN concept that include: Page 56
  • 57.
    CORE SWITCH • DISTRIBUTION SWITCHES • END SWITCHES These switches are monitored and managed 24x7 by Network Management System. Further Three Network concentrators are located at C&IT, CED and Doorvani bhawan. APPLICATIONS Computerisation at RSP comprises of several software modules which can be broadly divided into the following two categories: • BUSINESS ORIENTED APPLICATIONS • PROCESS ORIENTED APPLICATIONS BUSINESS APPLICATIONS @ JSPL Business oriented applications‟ broadly contains all those software modules which take care of the functional aspect of the plant operations, or process which are not directly participating in the production process. These software modules primarily are database operations. These are client oriented modules and have been developed and modified over years according to client needs. Some business applications include: • Production, Planning & Control area covering movement plan from CMO, planning, manufacturing operation, testing & inspection, despatches. • Sales invoicing from DA to accounts receivable • In Finance areas from on-line sectional computerization to profit & loss accounting including statutory requirements. • In Costing area from monthly cost sheet variance analysis to element wise cost analysis. • Human Resource Information System covering employees master data, orders, circulars, computerization of unit personnel offices. Page 57
  • 58.
    • Employee Servicesarea covering pay slip, PF slip, Income Tax, VRS schemes, incentive, bonus etc. till trial balance. • CMMS module covering preventive maintenance planning, shop scheduling, FMM equipment, Cranes, Repair Shop (Electrical). • Materials Management area from cataloging, indent, tender enquiry, order placement, inspection, receipts, issues, budget control, ABC analysis, lead time analysis & MIS. • Secondary Sales covering preparation of catalog of items from CDY, Idle Assets & Secondary Products for Forward Auction, award of lots, Sale/Disposal Sale Order, Delivery/Release Order, total SSSY operation. • Town Services covering quarter allotment to employees & non-employees, shop allotment, private party billing & revenue collection etc. • Hospital area covering indoor patient registration, non-entitled patient billing & revenue collection, central medicine store, dispensary & ward medicine accounting. • Plant Status for MD, EDs, GMs, HoDs and Plant Control. • CISF operations covering gate pass and loading sections. PROCESS CONTROL SYSTEMS @ RSP A general process control computer system consists of the following levels of distribution of responsibility, with two-way communication among peer-level as well as with higher levels: • Level-1 - direct digital control of process using PLC, DCS (Digital Control System) and Operator HMI (Human Machine Interface). • Level-2 - supervisory control level, for process tracking and optimization using a server type of computer and terminals. • Level-3 - infra-level coordination computers for production, planning and control functions. • Level-4 - scheduling, decision making, management information level. Page 58
  • 59.
    INFORMATION TECHNOLOGY ANDENTERPRISE RESOURCE PLANNING ERP IS SHORT FOR ENTERPRISE RESOURCE PLANNING. Enterprise resource planning (ERP) is business management software that allows an organization to use a system of integrated applications to manage the business. ERP software integrates all facets of an operation, including development, manufacturing, sales and marketing. ERP SOFTWARE MODULES ERP software consists of many enterprise software modules that are individually purchased, based on what best meets the specific needs and technical capabilities of the organization. Each ERP module is focused on one area of business processes, such as product development or marketing. Some of the more common ERP modules include those for product planning, material purchasing, inventory control, distribution, accounting, marketing, finance and HR. As the ERP methodology has become more popular, software applications have emerged to help business managers implement ERP in other business activities and may also incorporate modules for CRM and business intelligence -- and present them as a single unified package. The basic goal is to provide one central repository for all information that is shared by all the various ERP facets in order to smooth the flow of data across the organization. ERP VENDORS Depending on your organization's size and needs there are a number of enterprise resource planning software vendors to choose from in the large enterprise, midmarket and small business ERP markets. Page 59
  • 60.
    LARGE ENTERPRISE ERP(ERP TIER I) The ERP market for large enterprises is dominated by three companies: SAP, Oracle and Microsoft. (Source: Enterprise Apps Today; Enterprise ERP Buyer's Guide: SAP, Oracle and Microsoft; Drew Robb) MIDMARKET ERP (ERP TIER II) For the midmarket vendors include Infor, QAD, Lawson, Epicor, Sage and IFS. SMALL BUSINESS ERP (ERP TIER III) Exact Globe, Syspro, NetSuite, Visibility, Consona, CDC Software and Activant Solutions round out the ERP vendors for small businesses. (Source: EnterpriseAppsToday; ERP Buyer's Guide for Small Businesses; Drew Robb) ENTERPRISE RESOURCE PLANNING IN SALES 1 Ability to maintain a customer, product and price masters in sync with PPC system and CMO 2 Ability to maintain characteristic based price masters (Base price + quality extras+ technical delivery conditions, discounts, packing, freight charges and duties.) 3 Ability to upload masters from other systems 4 Ability to maintain the chapter subheading master 5 Ability to maintain Sales tax/ VAT/ ET masters 6 Ability to interface with PPC system to ensure that details of MP, DA, TC, RR are taken as source of information for invoicing purposes 7 Ability to interface with PPC System to obtain details of unit wise stock of Finished/ semi finished inventory, WIP, support stock valuation, Inventory ageing etc. product wise, quality wise and dimension wise Page 60
  • 61.
    8 Ability to interface with PPC system to obtain details of road despatches for invoicing and freight payment 9 Ability to auto generate invoices based on relevant data from MP, DA, TC, Customer, Product and Price masters without manual intervention 10 Ability to enter comment on invoice 11 Ability to pick up contracted price and rebate from MP 12 Ability to generate multiple invoices for single dispatch (with same or different paying addresses) 13 Ability to generate single invoice for multiple DAs/Multiple Wagons having different products 14 Ability to generate split invoices 15 Ability to trigger/ prompt invoice generation on DA creation 16 Ability to build in automated controls to match MP, Advice note and the test result to ensure that tests conducted are in line with the product, grade and TDCs sought by customer 17 Ability to reconcile DA, TC and MP to arrive at the final chargeable deliverables identified with proper UPC 18 Ability to prevent invoices from being raised if DA and TC do not match 19 Ability to auto generate invoice numbers based on business rules. The system should support both numeric and alpha numeric numbering 20 Ability to define separate number ranges for different classes of invoice 21 Ability to have flagging for various types of invoices i.e. direct/stockyard/sister plant/export/auction tender/internal consumption and others 22 Ability to provide effective date for price masters. Ability to pick up the correct prices from the master based on the effective date. Maintain trail of old price history. 23 Ability to lock an invoice once generated. Amendments / Cancellations should be only through proper approvals. Approval process should be through an automated work flow mechanism 24 Ability to generate provisional invoices and to suitably flag such invoices. 25 Ability to generate invoices with NIL excise duty, based on business rules 26 Ability to track cases where CENVAT credit has been reversed and cases where CENVAT credit is not reversed, in cases of invoices with NIL duty Page 61
  • 62.
    27 Ability to make manual adjustments in invoices if required in exceptional cases with strict controls and approvals 28 Ability to generate invoices for stockyard transfer cases where excise duty is paid considering the PPM Freight and Stock Yard Margin based on business rules 29 Ability to run sales journal and pass proper accounting entries for invoices generated for direct dispatches to customer 30 For stockyard transfer, ability to book sales based on actual sales at the branch and sales data and credit advices received from CMO 31 Ability to raise invoices including supplementary invoices and credit advices for Inter-Plant Transfers and ability to transfer and receive data online and trigger necessary accounting entries 32 Ability to capture data on internal consumption, raise invoice and trigger accounting entries for the same 33 Ability to support the modification/cancellation of invoices and tracking with the original invoice. ENTERPRISE RESOURCE PLANNING IN QUALITY MANAGEMENT • Ability to integrate quality management function with processes in materials management, sales & distribution, production planning and control and plant maintenance to ensure seamless flow of information • Ability to manage quality information for materials, vendors / suppliers / contractors, production, shops etc. • Ability to integrate quality management with cost accounting to capture costs of quality management functions • Ability for any concerned department from materials, operations, maintenance, finance to view the quality management information related to their respective departments • Ability to capture various accepted standards of BIS and other bodies in the system and revise them as and when required with track of changes • Ability to archive the soft copy version of RSP's Quality Manual • Ability to rate vendors / suppliers / contractors on quality parameters to help in addistions and revisions in list of registered vendors Page 62
  • 63.
    Ability to enter quality management data into the system in centralized and decentralized manner either from RCL or from multiple locations within JSPL plant • Ability to plan for resource requirements (personnel of various skills / qualifications / roles, test equipments / lab facilities etc.) for carrying out quality management functions • Ability to generate all documents (of lans, checklists, instruction sheets for test / inspection, result records, test certificates, reports, MIS etc.) required to carry on quality management functions QUALITY PLANNING • Ability to prepare a Quality Plan as part of the ABP / based on the ABP formulated which specifies target compositions / desired sizes of certain finshed products. • Ability to plan quality activities, accepted norms for the plant and industry, schedules, workflows etc. • Ability to certify vendors / manufacturers / contractors as well as monitoring their QM systems • Ability to define various business scenarios related to quality management using catalogs (by defects / deviations, follow-on actions, tasks, characteristics, attributes, chemical / physical / mechanical / process properties etc.) • Ability to define additional customized catalogs to capture RSP specific quality management parameters • Ability to define various inspection / test / analysis characteristics to describe the criteria for acceptance / rejection / down gradation etc. at the plant level • Ability to define the inspection / test / analysis methods for each characteristic defined to standardize and have uniformity of quality management process • Ability to define sampling strategy (sampling procedures / sampling schemes / rules of sampling) at various stages / departments of production, materials management and dispatch • Ability to enable inspection planning along with appropriate specifications in materials master, BOM / recipes, routings, work centres, test equipment masters, customer / vendor masters etc. Page 63
  • 64.
    Ability to prepare inspection / test schedules for the month / week / day considering available test / inspection resources and test / inspection requirements from materials, operations, maintenance, sales & dispatch to ensure better utilization Page 64
  • 65.
  • 66.
    Jindal Steel &Power Limited (JSPL), part of the US$ 1.8 billion. Jindal Organization; redefines dynamism. JSPL, an ISO-9002 and 14001certified company with its obsession for excellence, is increasing its portfolio of value added products, bringing the worlds best to India and making. an international mark. Production capabilities expanding to serve the infrastructure sector, catalyzing economic development and growth.JSPL has its integrated steel plant (as approved by Joint Plant Committee) at Raigarh in the state of Chhattisgarh, India. The facilities including world‟s largest coal based Sponge Iron Plant (installed capacity 650000 tpa) with six rotary kilns. Captive iron and coal mines make it one of the lowest cost producers of sponge iron. Growth and expansion plans include an additional 720000 MTPA capacity sponge iron plant comprising of four rotary kilns. The new plant is scheduled for commissioning by next year end. JSPL also has 150 MW power generation facility based on Waste Heat Recovery from rotary kilns, washery rejects and coal fines, which is being expanded to almost 300 MW by next year. FROM THE DESK OF EXEC. VC AND MD In today's era of fierce global competition, and rapid technological advances, an organization has to move twice as fast just to keep pace with the changing world and four times as fast if it has to speed ahead. At Jindal Steel and Power Ltd, we are in the process of achieving just that. At Raigarh, we have the world's largest coal based sponge iron manufacturing plant. JSPL is the only sponge iron producer in the country with its own raw material source and power generation making it one of the most cost effective producers of sponge iron in the country. We have taken yet another major step in putting India and Raigarh on the world steel map. A state of the art Rail and Universal Beam Mill has been set up, to Page 66
  • 67.
    manufacture the world'slongest rails 120 mts long for the Indian Railways and global markets. We are also the pioneers when it comes to manufacturing H-beams & Columns in larger sizes for the infrastructure and construction sectors. We are equally aware of our sense of duty as corporate citizens and the determined pursuit of business opportunity and global markets. In fact, our vision is to develop the backward and underdeveloped regions of India. Our facilities at Raigarh and Raipur fall under the newly formed state of Chattisgarh. We have been and will continue to stand committed to the progress of the state and it's people. At JSPL, we recognize that environmental protection is an integral part of the company's activities. We are committed to conducting our business safely, ethically and in an environmentally responsible manner that protects the natural resources and the environment in which we live. Our environment-friendly initiatives have been recognised and rewarded too. Our philosophy of moving up the value chain by increasing our portfolioof value added products continues. A zeal to be ahead of others, to venture where few dared has propelled us into ever increasing orbits of growth. The sectors we have chosen to operate mean that we will be serving key nationalpriorities, even as we build profitable businesses and create wealth for our shareholders. The unstinted support over the years from our investors, our clients, business associates and well-wishers, has been a great asset and we hope to continue to have them with us as we grow from strength to strength. Naveen Jindal Page 67
  • 68.
  • 69.
    CORPORATE PROFILE Jindal Steel& Power Limited (JSPL) part of the US $ 15 billion Jindal organization is in business of steel production, power generation, mining, sponge iron, ferro chrome and heavy machinery. JSPL Raigarh is 3 MTPA steel plant with world's largest coal-based sponge iron manufacturing facility and 340 MW captive power generation facility. The company has introduced innovative products like parallel flange beams & columns, which command more than half of the market share & 120m long finished rails. The company is implementing 6 MTPA integrated steel plant at Angul in Orissa, 6 MTPA integrated steel plant at Patratu in Jharkhand and a 1000 MW power plant at Raigarh through its subsidiary company Jindal Power Limited (JPL). JSPL is also in the process of investing US $ 2.1 Billion in Bolivia for setting up an integrated steel plant. Jindal Steel & Power Limited (JSPL) Raipur is a Machinery Division of Jindal Steel & Power Limited, Raigarh Page 69
  • 70.
    The Heavy MachineryDivision, Jindal Steel & Power Limited at Raipur was established in year 1992 with an objective to cater the requirement of companies within Jindal organization and other industries in the region. The division manufactures heavy machinery equipment i.e. Slab Caster, Rolling Mills, Structural Mills, Kilns, Blast Furnace, Sinter Plant etc. also we produce Steel Casting, Centrifugal Castings, Ingots and we are also established our Pressure Vessel Division for our up-coming Angul Projects and other Steel Plants. Now recently we have got certification of Indian Boiler Regulations- 1950, for manufacturing of equipments, machines like boilers etc. for Power Projects in India. This state of art division has a manufacturing capacity of 20,000 MPTA along with a capacity of 30,000 MPTA of steel ingots and casting and compares with the best in the region. The division can produce single piece steel casting up to 12 MT and has handling facility up to 150 MT. A wide range of machinery has been manufactured and supplied to companies like L&T MHI, South Eastern Coalfields, SAIL, Lafarge India, Garden Reach Ship Builders, HCL Kolkata, NMDC, Monet Ispat, JSPL Raigarh, JSL Hisar, Jindal Angul, Patratu & JSW Bellary etc. Page 70
  • 71.
  • 72.
    HOT ROLLED PARALLELFLANGE BEAMS AND COLUMN Every product has at least one USP, which can become its strongest point-and help the product sell more. The USP helps you position yourbrand distinctively. Another important component in fostering a marketing style is Value Addition and Hot rolled parallel flange beams and column are most sought after sections by structural engineers, architects and construction companies the world over. Advantages of using Parallel Flanges Beams and Column over ISMIB-   Greater choice of profile—with universal rolling method, there will be choice of large no. of beams and column with different weight in kg/in and statically properties in comparison to traditional I- beams on account of caliber rolling method. Page 72
  • 73.
      Facilitate boltedor welded construction— there is no taper in H beam flange. Flow drill and Hollo-bolt helps to produce bolted joints with hollow sections. Ensured quality of material and construction—the Parallel Flanges Beams have superiority in terms of strength, sectional efficiency, load bearing capacity, workability and economy in comparison to traditional beams. Reduced steel consumption—with the adoption of new technology the JSPL beams are cost effective because of less weight. The co. is able to save 15-30% of steel. Time-saving construction-pre-forined steel frames saves on construction time, they can be erected very fast and metal decking at floors ensures fast track, formwork-free construction.   Efficiency in construction-pre-fabricated and sleek steel reduces construction time which in turn reduces related costs including reduced interest during construction and quicker revenue generation. Page 73
  • 74.
     safety-everyone knowsmaterial weaken in fire, yet JSPL ignore this fact in design calculation.  Fire These are based on the strength of structural members at 20 degree C, and not on their reduced strength at elevated temperature of 600,800,1000 degree C or more. APPLICATIONS OF PARALLEL FLANGES BEAMS AND COLUMNS   Industrial Buildingsthe Parallel Flanges Beams have superiority in terms of strength, sectional efficiency, load bearing capacity, workability and economy in comparison to traditional beams. with the adoption of new technology the JSPL beams are cost effective because of less weight. The co. isable to save 15-30% of steel. pre-forined steel frames saves on construction time, they can be erected very fast and metal decking at floors ensures fast track, formwork-free construction. pre-fabricated and sleek steel reduces construction time which in turn reduces related costs including reduced interest during construction and quicker revenue generation. everyone knows material weaken in fire, yet JSPL ignore this fact in design calculation. These are based on the strength of structural members at 20 degree C, and not on their reduced strength at elevated temperature of 600,800,1000 degree C or more.  Multi-storey Buildings  Road bridge composite construction  buildings and car parks Utility Page 74
  • 75.
     Technological structures   Railways  Material handling system   Ports and harbors WORLDS LONGEST & INDIA „S ONLY 120M LONG “RAILS” JSPL believes in understanding the minutes of details of rail customer in order to provide them with foolproof solution, committed not only in supplying rails but in facilitating the building of a system of modern rail track for the Indian railways. JSPL has entered into a technical collaboration agreement with N7KKCorporation, Japan for technology transfer to produce superior quality, world‟s longest rails of 120m finished length, along with Parallel Flanges beams, column and Sheet piles for first time in the country. The agreement covers „know-how‟ transfer encompassing steelmaking, secondary refining and Page 75
  • 76.

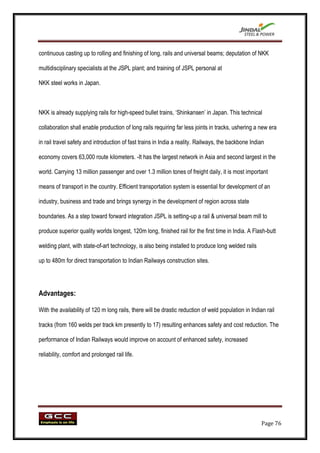

    continuous casting upto rolling and finishing of long, rails and universal beams; deputation of NKK multidisciplinary specialists at the JSPL plant; and training of JSPL personal at NKK steel works in Japan. NKK is already supplying rails for high-speed bullet trains, „Shinkansen‟ in Japan. This technical collaboration shall enable production of long rails requiring far less joints in tracks, ushering a new era in rail travel safety and introduction of fast trains in India a reality. Railways, the backbone Indian economy covers 63,000 route kilometers. -It has the largest network in Asia and second largest in the world. Carrying 13 million passenger and over 1.3 million tones of freight daily, it is most important means of transport in the country. Efficient transportation system is essential for development of an industry, business and trade and brings synergy in the development of region across state boundaries. As a step toward forward integration JSPL is setting-up a rail & universal beam mill to produce superior quality worlds longest, 120m long, finished rail for the first time in India. A Flash-butt welding plant, with state-of-art technology, is also being installed to produce long welded rails up to 480m for direct transportation to Indian Railways construction sites. Advantages: With the availability of 120 m long rails, there will be drastic reduction of weld population in Indian rail tracks (from 160 welds per track km presently to 17) resulting enhances safety and cost reduction. The performance of Indian Railways would improve on account of enhanced safety, increased reliability, comfort and prolonged rail life. Page 76
  • 77.
    Rail Steel‟s Quality& Product Range: Our comprehensive range of rail steels can be broadly classified as:Normal grade typified by 710 N/mm2 minimum UTS Wear resistant Grade typified by 880 N/ mm2 minimum UTS to 1080 N/mm2 UTS. Rails with higher UTS value as may be specified by international or domestic customers can be produced. Rail steels are produced in bothstandard carbon grades and micro-alloyed grades to meet the strength and quality requirement. The quality assurance system of JSPL today is certified by BSI- London for Quality BS:EN 9002:2000 and BS: EN 14001:1996 for Environmental Management System. Besides autonomous responsibility for self-checking, wherein products are qualified by self-certification, i.e. extensive internal and external inspection in conformity with customer requirements; we also follow the system of approval by third party inspections prior to dispatch. Page 77
  • 78.
    Today, the standardrequirements of rails must meet the operating needs ofthe railways for at least 20 years. It is this stringent quality norm which guides the company to manufacture products of high standards, placing JSPL at the forefront in the supply of rails. Specifications of Rails: JSPL rails are being rolled to different sections ranging from BS-75R (37.1 Kg/m) to UIC-70 (70 Kg/m): conforming to Indian Railways as well as internationalspecifications. Rails can be supplied in Page 78
  • 79.
    customized finished lengthsranging from 13 m to 120 m and flashbutt welded rails from 240 m up to 480 m. Some of the important specifications are listed below: S. No. Rail Sections Sectional Weight (kg/m) Specification* 1. P-75 74.41 GOST 2. UIC-60 60.34 UIC 3. UIC-54 E 53.823 UIC 4. IRS-52 51.89 IRS 5. UIC-50 50.88 UIC 6. TCDD-49 46.303 S-49 7. 48 Kg SAS 47.60 SAS 8. BS-90R 44.65 BS 9. BS-75R 37.1 B Page 79
  • 80.
    POWER expansion to 350MW on anvil. JSPL generates power to meet its captive requirements. The surplus power is supplied to Chhattisgarh state Electricity Board. The current generation of power is 150MW. Work on another 55MW plant has also been completed. Building upon the strength of our unshakeable foundations, JSPL is poised for a quantum leap in the core sector of power, contributing to the growing needs of the nation. At JSPL, we generate power to meet our captive requirements. In 1991, we entered this vital core sector by utilising waste heat from the rotary kiln boilers and the coal rejects of the washery. JSPL has 255 MW power generation facility with a capacity Page 80
  • 81.
    JSPL is oneof India's most economical power producers in the private sector. Jindal Power Limited has been established to sharpen our focus, leading to planned growth with a 1,000 MW. Thermal power plant being established in Raigarh district, about 40 kms from our existing plant. An MOU with the State Government has been signed and preliminary work on this project has already commenced. The serious intent of the JSPL foray into power can be gauged from its accelerated pace of expansion and meeting commitments not only on time but well in time. The thrust into this core sector is not only in keeping with our philosophy of creating opportunities where others see problems, but is also in complete synergy with the businesses we already are in. Our vision of utilising existing in-house strengths to fuel further growth has made us a force to reckon with. JSPL has a long-term commitment to this vital core sector. Jindal Power Limited will serve to further sharpen our focus on the power sector and thus lead to faster growth. SPONGE IRON The world's largest coal-based sponge iron facility Page 81
  • 82.
    JSPL is oneof the lowest-cost producers of sponge iron in India. Backward integration has given JSPL the distinction of being the only sponge iron manufacturer with its own captive raw material resources and power generation. This has enabled JSPL to monitor both price and quality of its products. At Raigarh, JSPL has the world's largest coal-based sponge iron manufacturing facility, with an installed capacity of 1.35M TPA, using ten rotary kilns. Sponge iron was the first production facility at the Raigarh plant, commissioned in 1991. In India, JSPL is the market leader in coalbased sponge iron, enjoying a market share of 22%. Today a major portion of our production is used for in-house manufacture of steel at JSPL and the other companies in the Jindal Organisation. As a key raw material for the manufacture of steel, our focus on sponge iron continues. The increased production is geared to meet our expanding capacities for value-added steel products in the years ahead. MINING- IRON ORE, GOAL & COAL WASHING Page 82
  • 83.
    JSPL has itsown iron ore mines at Tensa; district Sundergarh, Orrisa which produces 550,000 million tonne per annum (mtpa) of iron ore to meet the part requirement of Sponge Iron Plant. The company has its captive coal mines at Dongamahua, District Raigarh, and Chattisgarh with a capacity of 2.0 mtpa. Since the coal is of very poor grade and quality, it has to be beneficiated. Hence, a coal washery with a capacity of 2.5 mtpa to wash 47- 48% a coal ash to 26% has been commissioned and is operating successfully. The washery meets the requirements of sponge iron plant. Middling from the washery are being used for generation of captive power to tune of 100 MV. The captive mine is core strength of the company. FERRO CHROME Page 83
  • 84.
    Ferro chrome isan essential component in the manufacture of stainless steel and special steel. JSPL manufactures ferro chrome through the continuous smelting of chrome ore, coke, coal and quartz at the submerged arc furnace (SAF). At temperatures of 1600-1700oC, the chrome ore gets reduced by the carbon of the reductants. The SAF is tapped at regular intervals depending on the power input. Metal and slag come out together and by virtue of the higher specific gravity, the metal settles in the first receptacle. After solidification, the metal is removed from the receptacle and crushed to the required sizes. The emphasis on quality control is strict and in accordance with the stringent requirements of international standards. High-grade chrome ore is made available from captive chrome ore mines in Sukinda Valley of Orissa. Throughout the manufacturing process, special emphasis is laid on ensuring quality of the material at all levels. The plant is fully equipped with a state - of - the - art laboratory, complete with the latest high - techtesting facilities at par with the best manufacturers in the world. From each tapping, control samples are collected and analysed so as to maintain the international standards of product quality. Almost the entire production of ferro chrome(36,000 MTPA) is committed to India's leading manufacturer of stainless steel. An increase in production capacity is on the anvil and global markets are being tapped to sell the increased production. Page 84
  • 85.
    STEEL Steel at ourRaigarh plant is being manufactured using the Electric Arc Furnace. The steel melt shop (SMS) is equipped with ladle furnace and vacuum degassing and has continuous casting facilities for wide slabs, rounds and blooms. The capacity of SMS is 4, 00,000 MTPA. Steel at our Raigarh plant is being manufactured using the Electric Arc Furnace. The steel melt shop (SMS) is equipped with ladle furnace and vacuum degassing and has continuous casting facilities for wide slabs, rounds and blooms. The steel making capacity at present is 1.15 million TPA. JSPL has recently signed an MoU with the State Government of Orissa to set up a 2 million tonne steel plant with an investment of Rs.13,500 carores which would be expanded to 6 million tonne and another MoU has been signed with the State Government of Jharkhand to set up a 5 million steel plant with an investment of Rs.12,000 crores. Page 85
  • 86.
    Product Range Carbon &Alloy Steels confirming to National & International Standards like SAE, AISI, DIN,IS and ASTM . Size Range Billets : 150 x 150 mm squares. Length – upto 12 Metres ; Rhomboidity – 5mm (max) ; Bend – 5mm per Metre ; Width across flat – +4mm, -3mm ; Normal cast surface Bloom : 280mm x 320mm rectangle Round : 160mm diameter rounds Slabs : Width – 1000mm to 1500mm ; Thickness – 150mm & 200mm ; Length – 5.0metre to 9.0metre in 1250mm width , 3.0metre to 6.8metre in 1500mm width ;Rhomboidity – 5mm max ; Bulging - 2.5mm max; Camber – 2mm per Metre ; Normal cast surface On the Anvil Blooms: 285mm x 390mm rectangle Rounds : 200mm & 220mm diameter. Page 86
  • 87.
  • 88.
    SWOT ANALYSIS While conductingOrganisational Study of any of the organisation it is important to take into account not only the organisation‟s business but also its competitors business as well. The following description will highlight the Strength, Weakness, Opportunity and Threats of Jindal Steel and Power STRENGTH:- 1) Competitor‟s price of product is most powerful weapon for the company. 2) Highly equipped and modern technological manufacturing plant. 3) Quality control of product in each stage and technological quality checking of each product. 4) Using highly competitive Raw material 5) Sufficient Human Resource power 6) Customer Satisfaction through supplying product in time 7) Providing good services to customer 8) Skilled and highly Experienced Department Heads. WEAKNESS:-. 1) Less scope for diversification of product. OPPORTUNITY:- 1) Growing Steel and Power Industry Page 88
  • 89.
    2) Availability ofskilled labours and policy Support. 3) Huge export opportunity 4) Availability of well connected road network THREATS:- 1) Fluctuating policies of the government and ecological imbalances. 2) Competitors. Page 89
  • 90.
    MISSION, VISION &VALUES Vision “To be a globally admired organization that enhances the quality of life of all stakeholders through sustainable industrial and business development” Mission We aspire to achieve business excellence through- • The spirit of entrepreneurship and innovation • Optimum utilization of resources • The highest ethics and standards • Maximizing returns to stakeholders Values • Passion for people • Business excellence • Integrity, ownership and and source of belonging Page 90
  • 91.
    Sustainable development Page 91
  • 92.
  • 93.
    FINDINGS:- 1)Jindal Steel and Power is one of the fast growing companies and has a good Technical support from their employees. They all are well qualified and also are well trained personnel. 2) The company provides good working condition training facilities to its employees. 3) The company is having highly equipped modern manufacturing plant and other facilities. 4) Jindal steel and power has its Quality control and Quality assurance as its strength. Page 93
  • 94.
    SUGESSIONS AND RECOMMENDATION:- As the company is ISO registered which itself ensures the high quality of work and in turn the ensures about the production of best quality of product. Thus, from my behalf as a trainee the suggestion or the recommendation will be that the organisation should try to keep up with good work and should change accordingly with the change in technology and other requirement if any. Page 94
  • 95.

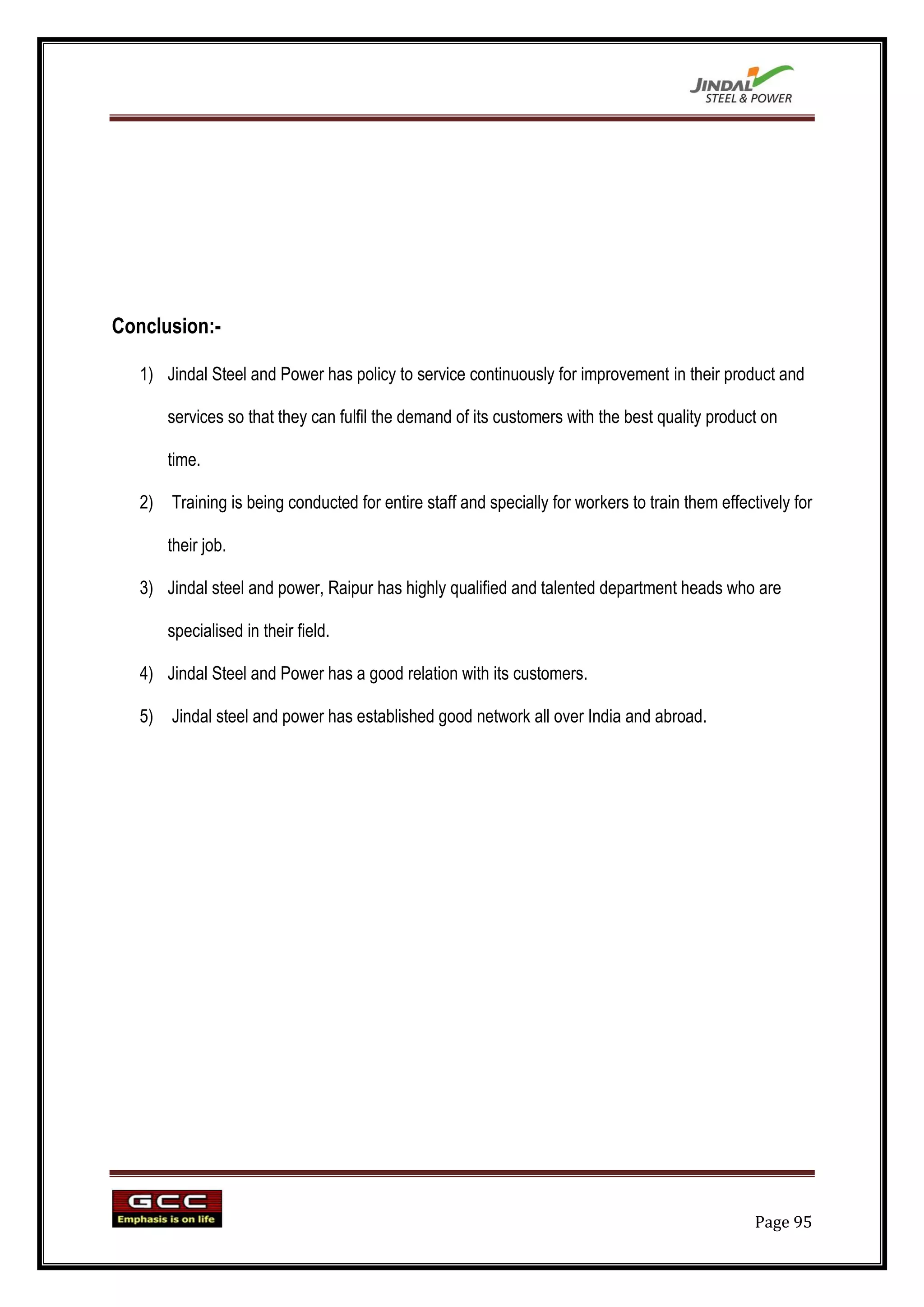

    Conclusion:- 1) Jindal Steel and Power has policy to service continuously for improvement in their product and services so that they can fulfil the demand of its customers with the best quality product on time. 2) Training is being conducted for entire staff and specially for workers to train them effectively for their job. 3) Jindal steel and power, Raipur has highly qualified and talented department heads who are specialised in their field. 4) Jindal Steel and Power has a good relation with its customers. 5) Jindal steel and power has established good network all over India and abroad. Page 95
  • 96.
  • 97.
  • 98.
    BIBLIOGRAPHY:- 1)JSPL Brochures and Manuals. 2) Website- www.jindalsteelpower.com. 3) Newspapers. 4) Search Magazines. 5) Electrical media. Page 98
