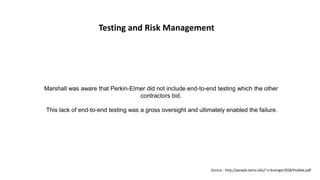

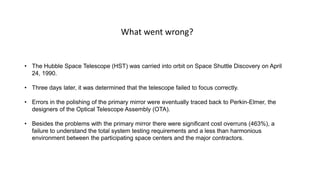

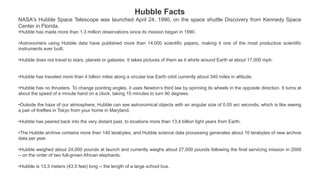

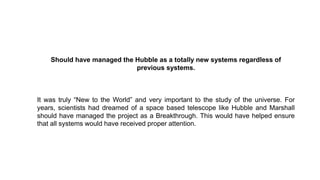

The Hubble Space Telescope project encountered significant problems including cost overruns, scheduling issues, and technical errors in construction. Specifically, the primary mirror of the telescope was polished incorrectly, resulting in blurred images. An investigation found that Perkin-Elmer, the contractor responsible for the mirror, failed to conduct proper end-to-end testing. Additionally, NASA underestimated the technical challenges and pushed unrealistic deadlines in an effort to control costs and secure continued funding for the project.
