Get Ready Now for HITRUST 2017 | 1
Get Ready Now for
HITRUST 2017
Your Map to HITRUST
Certification
Get Ready Now for HITRUST 2017 | 2

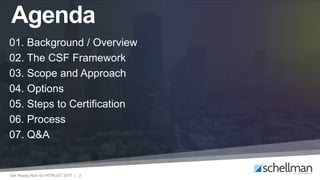

01. Background / Overview
02. The CSF Framework
03. Scope and Approach
04. Options
05. Steps to Certification
06. Process
07. Q&A
Agenda
Get Ready Now for HITRUST 2017 | 3
Background
& Overview
01
Get Ready Now for HITRUST 2017 | 4
HITRUST Overview
• Began in 2007, first version released in 2009
• Meet demand of healthcare challenges
– Inconsistency
– Inefficiencies
– Increasing cost
– Increasing risk
Get Ready Now for HITRUST 2017 | 5
Announcement
Get Ready Now for HITRUST 2017 | 6
Overview of Expansion
• CSF Certification
• Anthem/Cigna, Health Care Services Corp.,
Highmark, Humana, and UnitedHealth
Group Significance
• Effective security and privacy practices
Get Ready Now for HITRUST 2017 | 7
Why the Expansion?
• Increasing cyber threats
• Significance of Business Associates
• Interconnection of healthcare industry
• Beyond HIPAA
• Minimize the duplicity, costs and inefficiencies
Get Ready Now for HITRUST 2017 | 8
Mandatory?
YES!
(For Business Associates of these Healthcare Organizations)
Get Ready Now for HITRUST 2017 | 9
7,500An additional 7,500 organizations that do not currently have a CSF
Certification do so with within the next 24 months.
Get Ready Now for HITRUST 2017 | 10
Overview of the
Common Security
Framework02
Get Ready Now for HITRUST 2017 | 11
CSF Overview
• CSF
– Defined set of requirements
– Prescriptive requirements
– Meet the challenges in healthcare security
– Secure protected health information
Get Ready Now for HITRUST 2017 | 12

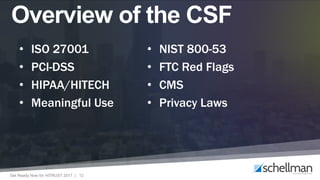

Overview of the CSF
• ISO 27001
• PCI-DSS
• HIPAA/HITECH
• Meaningful Use
• NIST 800-53
• FTC Red Flags
• CMS
• Privacy Laws
Get Ready Now for HITRUST 2017 | 13
Organization of the CSF
• Establishes a single benchmark
• Increases trust and transparency
• Obtains industry consensus
Get Ready Now for HITRUST 2017 | 14
CSF and Privacy
• CSF version 7
– Inclusion of privacy
– Satisfy health care regulations in TX, MA, and NV
Get Ready Now for HITRUST 2017 | 15
Purpose
& Scope
03
Get Ready Now for HITRUST 2017 | 16
Purpose
• Harmonizes privacy and security standards
• Establishes framework of controls
• Build trust and assurance
• Highlights credibility
• Helps eliminate the need for redundant audits
Get Ready Now for HITRUST 2017 | 17
Define Scope
• Entire organization environment
• Segmented portions
– Single location
– Single business unit
– Single application
• Covered information
Get Ready Now for HITRUST 2017 | 18
Define Scope
• Assessment options
– Security Assessment
– Security & Privacy Assessment
– Comprehensive Security Assessment
– Comprehensive Security & Privacy Assessment
Get Ready Now for HITRUST 2017 | 19
Scope of CSF
• Assessment factors
– Organizational factors
– System factors
– Regulatory factors
Get Ready Now for HITRUST 2017 | 20
Scope of CSF
• 14 control categories
– 13 for Security
– 1 for Privacy
• 46 control objectives
• 149 control specifications
– Grouped within 19 assessment domains
Get Ready Now for HITRUST 2017 | 21

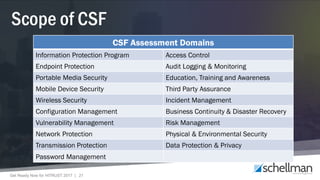

Scope of CSF
CSF Assessment Domains
Information Protection Program Access Control
Endpoint Protection Audit Logging & Monitoring
Portable Media Security Education, Training and Awareness
Mobile Device Security Third Party Assurance
Wireless Security Incident Management
Configuration Management Business Continuity & Disaster Recovery
Vulnerability Management Risk Management
Network Protection Physical & Environmental Security
Transmission Protection Data Protection & Privacy
Password Management
Get Ready Now for HITRUST 2017 | 22

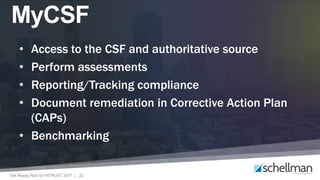

MyCSF
• Access to the CSF and authoritative source
• Perform assessments
• Reporting/Tracking compliance
• Document remediation in Corrective Action Plan
(CAPs)
• Benchmarking
Get Ready Now for HITRUST 2017 | 23

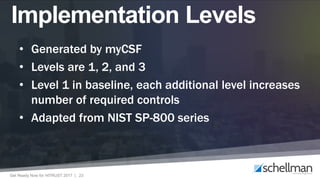

Implementation Levels
• Generated by myCSF
• Levels are 1, 2, and 3
• Level 1 in baseline, each additional level increases
number of required controls
• Adapted from NIST SP-800 series
Get Ready Now for HITRUST 2017 | 24
Options
04
Get Ready Now for HITRUST 2017 | 25
• Self Assessment
• CSF Validated
Assessment Types

Get Ready Now for HITRUST 2017 | 26
• Self Assessment
• CSF Validated
Assessment Types
Get Ready Now for HITRUST 2017 | 27
• Self Assessment
– No validation
– 3rd party can facilitate assessment
– 3rd party can provide review and feedback
Assessment Types
Get Ready Now for HITRUST 2017 | 28
• Validated
– HITRUST approved CSF Assessor
– On-site fieldwork
• Interviews
• Technical testing
Assessment Types
Get Ready Now for HITRUST 2017 | 29

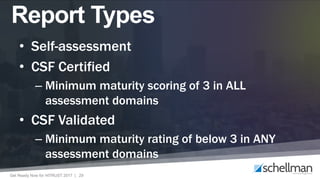

• Self-assessment
• CSF Certified
– Minimum maturity scoring of 3 in ALL
assessment domains
• CSF Validated
– Minimum maturity rating of below 3 in ANY
assessment domains
Report Types
Get Ready Now for HITRUST 2017 | 30
Steps to
Certification
05
Get Ready Now for HITRUST 2017 | 31
oneInitial Project Planning
Get Ready Now for HITRUST 2017 | 32
• Executive support
• Assignment of a main point of contact
• Determining scope
• Determining system boundaries
• Communication with process owners
Project Planning
Get Ready Now for HITRUST 2017 | 33
twoOrganizational and
System Scoping
Get Ready Now for HITRUST 2017 | 34
• Location(s)
• Application(s)
• Device(s)
• Regulatory requirement(s)
• Third party service organization(s)
Organizational and System
Scoping
Get Ready Now for HITRUST 2017 | 35
threeAssessment Preparation
Get Ready Now for HITRUST 2017 | 36
• Project calendars
• Evidence request lists
• Identification of process owners
• Interview scheduling
Assessment Preparation
Get Ready Now for HITRUST 2017 | 37
fourExamine Documentation
and Practices
Get Ready Now for HITRUST 2017 | 38
• Policy documents
• Documented procedures
• Processes
Examine Documentation
and Practices
Get Ready Now for HITRUST 2017 | 39
fiveConduct Interviews
Get Ready Now for HITRUST 2017 | 40
• Process owners
• Verify process controls
• Confirmation of evidence
Conduct Interviews
Get Ready Now for HITRUST 2017 | 41
sixPerform Review and
Technical Testing
Get Ready Now for HITRUST 2017 | 42
• Perform walkthroughs
• Automated control configurations
• Manual control sampling
– HITRUST sampling methodology
Perform Technical Testing
Get Ready Now for HITRUST 2017 | 43
• Compliance scoring
– Control requirement
• Policy
• Procedure
• Implemented
• Managed
• Measured
Review Technical Testing
Get Ready Now for HITRUST 2017 | 44
• Compliance scoring
– Control requirement
• Policy
• Procedure
• Implemented
• Managed
• Measured
Review Technical Testing
– Maturity rating
• Non-compliant (0%)
• Somewhat compliant (25%)
• Partially compliant (50%)
• Mostly compliant (75%)
• Fully compliant (100%)
Get Ready Now for HITRUST 2017 | 45

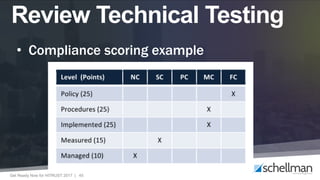

• Compliance scoring example
Review Technical Testing
Get Ready Now for HITRUST 2017 | 46
sevenAlternate Control
Identification and Selection
Get Ready Now for HITRUST 2017 | 47
• Only if non-compliant CSF controls exist
• Identify compensating controls
• Residual compliance scoring
Alternate Control
Identification and Testing
Get Ready Now for HITRUST 2017 | 48
eightReporting
Get Ready Now for HITRUST 2017 | 49
• Prepare for submission to HITRUST
– Assessor testing
– Management representation letter
– Remediation plans (CAPs)
• HITRUST QA Review
– 4 – 6 weeks
Reporting
Get Ready Now for HITRUST 2017 | 50
nineRemediation Tracking
Get Ready Now for HITRUST 2017 | 51
• Corrective Action Plan (CAP) progress
– CAP Owner
– Implementation plan
– Expected completion date
• Residual risk score adjustments
Remediation Tracking
Get Ready Now for HITRUST 2017 | 52
The Certification
Process
06
Get Ready Now for HITRUST 2017 | 53
Issuing Certification
Get Ready Now for HITRUST 2017 | 54
Issuing Certification
Get Ready Now for HITRUST 2017 | 55
Issuing Certification
Get Ready Now for HITRUST 2017 | 56
Issuing Certification
Get Ready Now for HITRUST 2017 | 57
Issuing Certification
• Valid 2 years
– Annual review
• Within 2 months following the 1-year anniversary
• Continuous monitoring requirements
– CAP remediation
Get Ready Now for HITRUST 2017 | 58
LEARN MORE ABOUT HITRUST
click here

Get Ready Now for HITRUST 2017

  • 1.
    Get Ready Nowfor HITRUST 2017 | 1 Get Ready Now for HITRUST 2017 Your Map to HITRUST Certification
  • 2.
    Get Ready Nowfor HITRUST 2017 | 2 01. Background / Overview 02. The CSF Framework 03. Scope and Approach 04. Options 05. Steps to Certification 06. Process 07. Q&A Agenda
  • 3.
    Get Ready Nowfor HITRUST 2017 | 3 Background & Overview 01
  • 4.
    Get Ready Nowfor HITRUST 2017 | 4 HITRUST Overview • Began in 2007, first version released in 2009 • Meet demand of healthcare challenges – Inconsistency – Inefficiencies – Increasing cost – Increasing risk
  • 5.
    Get Ready Nowfor HITRUST 2017 | 5 Announcement
  • 6.
    Get Ready Nowfor HITRUST 2017 | 6 Overview of Expansion • CSF Certification • Anthem/Cigna, Health Care Services Corp., Highmark, Humana, and UnitedHealth Group Significance • Effective security and privacy practices
  • 7.
    Get Ready Nowfor HITRUST 2017 | 7 Why the Expansion? • Increasing cyber threats • Significance of Business Associates • Interconnection of healthcare industry • Beyond HIPAA • Minimize the duplicity, costs and inefficiencies
  • 8.
    Get Ready Nowfor HITRUST 2017 | 8 Mandatory? YES! (For Business Associates of these Healthcare Organizations)
  • 9.
    Get Ready Nowfor HITRUST 2017 | 9 7,500An additional 7,500 organizations that do not currently have a CSF Certification do so with within the next 24 months.
  • 10.
    Get Ready Nowfor HITRUST 2017 | 10 Overview of the Common Security Framework02
  • 11.
    Get Ready Nowfor HITRUST 2017 | 11 CSF Overview • CSF – Defined set of requirements – Prescriptive requirements – Meet the challenges in healthcare security – Secure protected health information
  • 12.
    Get Ready Nowfor HITRUST 2017 | 12 Overview of the CSF • ISO 27001 • PCI-DSS • HIPAA/HITECH • Meaningful Use • NIST 800-53 • FTC Red Flags • CMS • Privacy Laws
  • 13.
    Get Ready Nowfor HITRUST 2017 | 13 Organization of the CSF • Establishes a single benchmark • Increases trust and transparency • Obtains industry consensus
  • 14.
    Get Ready Nowfor HITRUST 2017 | 14 CSF and Privacy • CSF version 7 – Inclusion of privacy – Satisfy health care regulations in TX, MA, and NV
  • 15.
    Get Ready Nowfor HITRUST 2017 | 15 Purpose & Scope 03
  • 16.
    Get Ready Nowfor HITRUST 2017 | 16 Purpose • Harmonizes privacy and security standards • Establishes framework of controls • Build trust and assurance • Highlights credibility • Helps eliminate the need for redundant audits
  • 17.
    Get Ready Nowfor HITRUST 2017 | 17 Define Scope • Entire organization environment • Segmented portions – Single location – Single business unit – Single application • Covered information
  • 18.
    Get Ready Nowfor HITRUST 2017 | 18 Define Scope • Assessment options – Security Assessment – Security & Privacy Assessment – Comprehensive Security Assessment – Comprehensive Security & Privacy Assessment
  • 19.
    Get Ready Nowfor HITRUST 2017 | 19 Scope of CSF • Assessment factors – Organizational factors – System factors – Regulatory factors
  • 20.
    Get Ready Nowfor HITRUST 2017 | 20 Scope of CSF • 14 control categories – 13 for Security – 1 for Privacy • 46 control objectives • 149 control specifications – Grouped within 19 assessment domains
  • 21.
    Get Ready Nowfor HITRUST 2017 | 21 Scope of CSF CSF Assessment Domains Information Protection Program Access Control Endpoint Protection Audit Logging & Monitoring Portable Media Security Education, Training and Awareness Mobile Device Security Third Party Assurance Wireless Security Incident Management Configuration Management Business Continuity & Disaster Recovery Vulnerability Management Risk Management Network Protection Physical & Environmental Security Transmission Protection Data Protection & Privacy Password Management
  • 22.
    Get Ready Nowfor HITRUST 2017 | 22 MyCSF • Access to the CSF and authoritative source • Perform assessments • Reporting/Tracking compliance • Document remediation in Corrective Action Plan (CAPs) • Benchmarking
  • 23.
    Get Ready Nowfor HITRUST 2017 | 23 Implementation Levels • Generated by myCSF • Levels are 1, 2, and 3 • Level 1 in baseline, each additional level increases number of required controls • Adapted from NIST SP-800 series
  • 24.
    Get Ready Nowfor HITRUST 2017 | 24 Options 04
  • 25.
    Get Ready Nowfor HITRUST 2017 | 25 • Self Assessment • CSF Validated Assessment Types
  • 26.
    Get Ready Nowfor HITRUST 2017 | 26 • Self Assessment • CSF Validated Assessment Types
  • 27.
    Get Ready Nowfor HITRUST 2017 | 27 • Self Assessment – No validation – 3rd party can facilitate assessment – 3rd party can provide review and feedback Assessment Types
  • 28.
    Get Ready Nowfor HITRUST 2017 | 28 • Validated – HITRUST approved CSF Assessor – On-site fieldwork • Interviews • Technical testing Assessment Types
  • 29.
    Get Ready Nowfor HITRUST 2017 | 29 • Self-assessment • CSF Certified – Minimum maturity scoring of 3 in ALL assessment domains • CSF Validated – Minimum maturity rating of below 3 in ANY assessment domains Report Types
  • 30.
    Get Ready Nowfor HITRUST 2017 | 30 Steps to Certification 05
  • 31.
    Get Ready Nowfor HITRUST 2017 | 31 oneInitial Project Planning
  • 32.
    Get Ready Nowfor HITRUST 2017 | 32 • Executive support • Assignment of a main point of contact • Determining scope • Determining system boundaries • Communication with process owners Project Planning
  • 33.
    Get Ready Nowfor HITRUST 2017 | 33 twoOrganizational and System Scoping
  • 34.
    Get Ready Nowfor HITRUST 2017 | 34 • Location(s) • Application(s) • Device(s) • Regulatory requirement(s) • Third party service organization(s) Organizational and System Scoping
  • 35.
    Get Ready Nowfor HITRUST 2017 | 35 threeAssessment Preparation
  • 36.
    Get Ready Nowfor HITRUST 2017 | 36 • Project calendars • Evidence request lists • Identification of process owners • Interview scheduling Assessment Preparation
  • 37.
    Get Ready Nowfor HITRUST 2017 | 37 fourExamine Documentation and Practices
  • 38.
    Get Ready Nowfor HITRUST 2017 | 38 • Policy documents • Documented procedures • Processes Examine Documentation and Practices
  • 39.
    Get Ready Nowfor HITRUST 2017 | 39 fiveConduct Interviews
  • 40.
    Get Ready Nowfor HITRUST 2017 | 40 • Process owners • Verify process controls • Confirmation of evidence Conduct Interviews
  • 41.
    Get Ready Nowfor HITRUST 2017 | 41 sixPerform Review and Technical Testing
  • 42.
    Get Ready Nowfor HITRUST 2017 | 42 • Perform walkthroughs • Automated control configurations • Manual control sampling – HITRUST sampling methodology Perform Technical Testing
  • 43.
    Get Ready Nowfor HITRUST 2017 | 43 • Compliance scoring – Control requirement • Policy • Procedure • Implemented • Managed • Measured Review Technical Testing
  • 44.
    Get Ready Nowfor HITRUST 2017 | 44 • Compliance scoring – Control requirement • Policy • Procedure • Implemented • Managed • Measured Review Technical Testing – Maturity rating • Non-compliant (0%) • Somewhat compliant (25%) • Partially compliant (50%) • Mostly compliant (75%) • Fully compliant (100%)
  • 45.
    Get Ready Nowfor HITRUST 2017 | 45 • Compliance scoring example Review Technical Testing
  • 46.
    Get Ready Nowfor HITRUST 2017 | 46 sevenAlternate Control Identification and Selection
  • 47.
    Get Ready Nowfor HITRUST 2017 | 47 • Only if non-compliant CSF controls exist • Identify compensating controls • Residual compliance scoring Alternate Control Identification and Testing
  • 48.
    Get Ready Nowfor HITRUST 2017 | 48 eightReporting
  • 49.
    Get Ready Nowfor HITRUST 2017 | 49 • Prepare for submission to HITRUST – Assessor testing – Management representation letter – Remediation plans (CAPs) • HITRUST QA Review – 4 – 6 weeks Reporting
  • 50.
    Get Ready Nowfor HITRUST 2017 | 50 nineRemediation Tracking
  • 51.
    Get Ready Nowfor HITRUST 2017 | 51 • Corrective Action Plan (CAP) progress – CAP Owner – Implementation plan – Expected completion date • Residual risk score adjustments Remediation Tracking
  • 52.
    Get Ready Nowfor HITRUST 2017 | 52 The Certification Process 06
  • 53.
    Get Ready Nowfor HITRUST 2017 | 53 Issuing Certification
  • 54.
    Get Ready Nowfor HITRUST 2017 | 54 Issuing Certification
  • 55.
    Get Ready Nowfor HITRUST 2017 | 55 Issuing Certification
  • 56.
    Get Ready Nowfor HITRUST 2017 | 56 Issuing Certification
  • 57.
    Get Ready Nowfor HITRUST 2017 | 57 Issuing Certification • Valid 2 years – Annual review • Within 2 months following the 1-year anniversary • Continuous monitoring requirements – CAP remediation
  • 58.
    Get Ready Nowfor HITRUST 2017 | 58 LEARN MORE ABOUT HITRUST click here
