Embed presentation
Download as PDF, PPTX

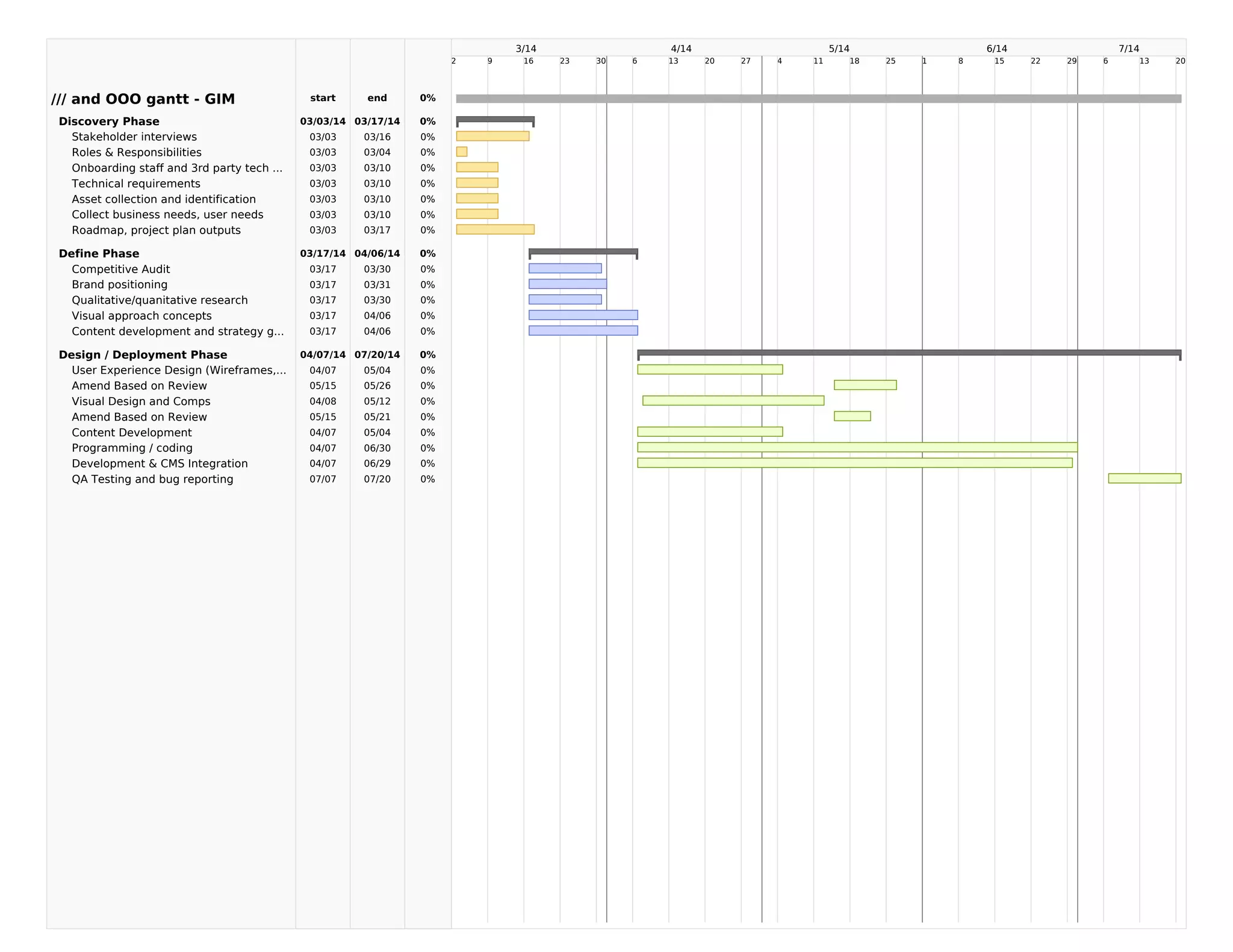

The document outlines a project plan with phases for discovery, definition, and design/deployment. The discovery phase includes stakeholder interviews and defining requirements from March 3-17. The definition phase focuses on research and strategy from March 17-April 6. User experience design, visual design, content development, and testing are scheduled from April 7-July 20 in the design/deployment phase.
