BerryDunn Presentation to the City of College Station
City Council

Consultation on ERP Assessment and
Evaluation

Thursday, March 28, 2013

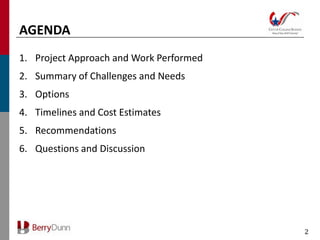

AGENDA
1. Project Approach and Work Performed
2. Summary of Challenges and Needs
3. Options
4. Timelines and Cost Estimates
5. Recommendations
6. Questions and Discussion

                                         2
3

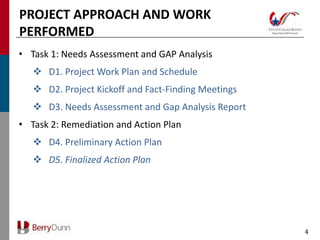

PROJECT APPROACH AND WORK
PERFORMED
• Task 1: Needs Assessment and GAP Analysis
    D1. Project Work Plan and Schedule
    D2. Project Kickoff and Fact-Finding Meetings
    D3. Needs Assessment and Gap Analysis Report
• Task 2: Remediation and Action Plan
    D4. Preliminary Action Plan
    D5. Finalized Action Plan

                                                     4
5

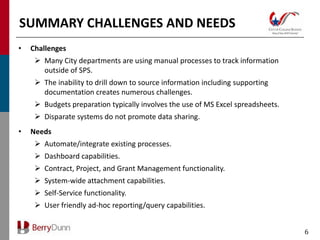

SUMMARY CHALLENGES AND NEEDS
•   Challenges
      Many City departments are using manual processes to track information
       outside of SPS.
      The inability to drill down to source information including supporting
       documentation creates numerous challenges.
      Budgets preparation typically involves the use of MS Excel spreadsheets.
      Disparate systems do not promote data sharing.
•   Needs
      Automate/integrate existing processes.
      Dashboard capabilities.
      Contract, Project, and Grant Management functionality.
      System-wide attachment capabilities.
      Self-Service functionality.
      User friendly ad-hoc reporting/query capabilities.

                                                                                  6
7

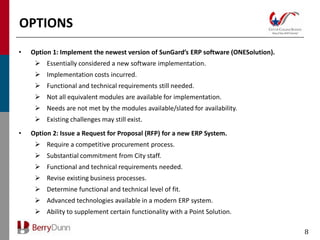

OPTIONS
•   Option 1: Implement the newest version of SunGard’s ERP software (ONESolution).
      Essentially considered a new software implementation.
      Implementation costs incurred.
      Functional and technical requirements still needed.
      Not all equivalent modules are available for implementation.
      Needs are not met by the modules available/slated for availability.
      Existing challenges may still exist.
•   Option 2: Issue a Request for Proposal (RFP) for a new ERP System.
      Require a competitive procurement process.
      Substantial commitment from City staff.
      Functional and technical requirements needed.
      Revise existing business processes.
      Determine functional and technical level of fit.
      Advanced technologies available in a modern ERP system.
      Ability to supplement certain functionality with a Point Solution.

                                                                                      8
9

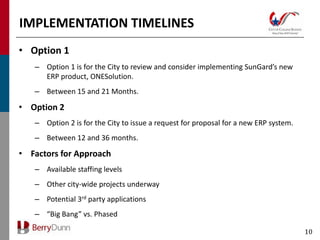

IMPLEMENTATION TIMELINES
• Option 1
   – Option 1 is for the City to review and consider implementing SunGard’s new
     ERP product, ONESolution.
   – Between 15 and 21 Months.

• Option 2
   – Option 2 is for the City to issue a request for proposal for a new ERP system.
   – Between 12 and 36 months.

• Factors for Approach
   – Available staffing levels
   – Other city-wide projects underway
   – Potential 3rd party applications
   – “Big Bang” vs. Phased

                                                                                      10

RFI COST ESTIMATES
                          Adjusted Average One-Time ERP Cost Estimates ($)

 Vendor      Average Est.       20% Increase    30% Increase     40% Increase   50% Increase

 Velocity     $2,860,000          $3,432,000      $3,718,000       $4,004,000    $4,290,000

  Tyler       $1,860,000          $2,232,000      $2,418,000       $2,604,000    $2,790,000

Microsoft     $2,020,000          $2,424,000      $2,626,000       $2,828,000    $3,030,000

 Oracle        $945,000           $1,134,000      $1,229,000       $1,323,000    $1,418,000

 SunGard       $645,000           $774,000         $839,000         $903,000      $968,000

                  Adjusted Average One-Time Point Solution Cost Estimates ($)

 Vendor      Average Est.       20% Increase    30% Increase     40% Increase   50% Increase

Advanced
              $1,309,000          $1,571,000      $1,702,000       $1,833,000    $1,964,000
 Utilities

 EnerGov       $548,000           $658,000         $713,000         $767,000      $822,000

                                                                                               11

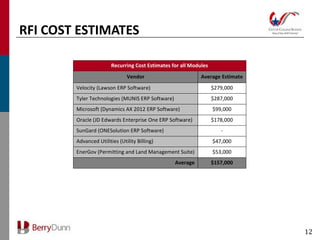

RFI COST ESTIMATES

                        Recurring Cost Estimates for all Modules
                               Vendor                        Average Estimate
        Velocity (Lawson ERP Software)                             $279,000
        Tyler Technologies (MUNIS ERP Software)                    $287,000
        Microsoft (Dynamics AX 2012 ERP Software)                  $99,000
        Oracle (JD Edwards Enterprise One ERP Software)            $178,000
        SunGard (ONESolution ERP Software)                            -
        Advanced Utilities (Utility Billing)                       $47,000
        EnerGov (Permitting and Land Management Suite)             $53,000
                                                  Average          $157,000

                                                                                12
13

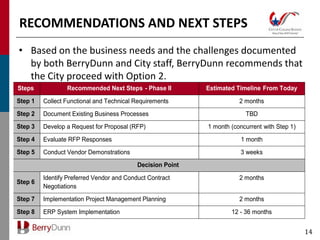

RECOMMENDATIONS AND NEXT STEPS
• Based on the business needs and the challenges documented
  by both BerryDunn and City staff, BerryDunn recommends that
  the City proceed with Option 2.
Steps            Recommended Next Steps - Phase II          Estimated Timeline From Today
Step 1   Collect Functional and Technical Requirements                 2 months
Step 2   Document Existing Business Processes                            TBD
Step 3   Develop a Request for Proposal (RFP)               1 month (concurrent with Step 1)
Step 4   Evaluate RFP Responses                                         1 month
Step 5   Conduct Vendor Demonstrations                                 3 weeks
                                           Decision Point
         Identify Preferred Vendor and Conduct Contract                2 months
Step 6
         Negotiations
Step 7   Implementation Project Management Planning                    2 months
Step 8   ERP System Implementation                                  12 - 36 months

                                                                                               14
15
QUESTIONS AND DISCUSSION

                 Thank you!

                     
                   BerryDunn
               100 Middle Street
             Portland, Maine 04104
              Tel: (207) 775-2387
              Fax: (207) 774-2375

                                     16
