Urban Ministry Center

Education Center Proposal

              for

      Moore Place




           Submitted by:

        Maria J. Burt, M.Ed.
         October 29, 2009
The

Future
Future
is not some   PLACE
  we are going, but

     one we are

  CREATING.
 the PATHS are

not to be found, but

 MADE. And the
 activity of making

them   CHANGES
       both the
 MAKERS and
        their

DESTINATION.
              + John Schaar
Contents


Why Should the Urban Ministry Center Have Its Own Education Center?   1

What Would Be Taught?                                                 1

Who Will Staff the Center?                                            1

What Materials Would Be Required?                                     3

Costs                                                                 4

Who Would Pay for This?                                               6

How Can We Convince Funders to Pay for the Education Center?          6
         Computer-Assisted Instruction (CAI)                          6

How Shall We Begin?                                                   7

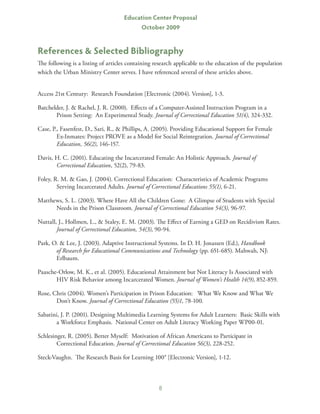

References  Selected Bibliography                                    8
Education Center Proposal
                                             October 2009


Why Should the Urban Ministry Center
Have Its Own Education Center?
To provide Urban Ministry Center program participants with maximum opportunities to increase
their educational levels and essential work skills so that the possibility of their job success and integra-
tion in society will be improved. The quality of consistent, compassionate relationships between vol-
unteer teachers and students will be key. Having educational programs and activities on-site in a safe,
supportive, and quietly purposeful environment will greatly increase the probability that program par-
ticipants will succeed at their educational endeavors. Additionally, the Education Center will become a
focal point for building community among residents, volunteers, and the wider Charlotte community.
The addition of an education center will augment the overall success of Moore Place’s mission to pro-
vide supportive housing for chronically homeless individuals in the Charlotte area.


What Would Be Taught?
    •	 Adult Basic Education (ABE) courses, pre-GED and GED preparation courses using
       Computer-Assisted Instruction (CAI). CAI has been shown to be especially effective with
       special populations such as chronically homeless individuals. Individual tutoring, formal and
       informal classroom instruction, writers workshops, etc. would also be provided.
    •	 Beginning and advanced computer classes (e.g., basic keyboard skills, introduction to
       computers, Microsoft Office Suite at all levels).
    •	 On a regular basis and in small groups schedule:
            *	   field trips
            *	   cultural opportunities
            *	   sporting activities
            *	   cooking classes
            *	   crafts classes
            *	   household management classes
            *	   personal finance classes, including budget and income tax preparation
            *	   classes in professional dress and behavior
            *	   assistance with legal issues
            *	   other topics as they present themselves

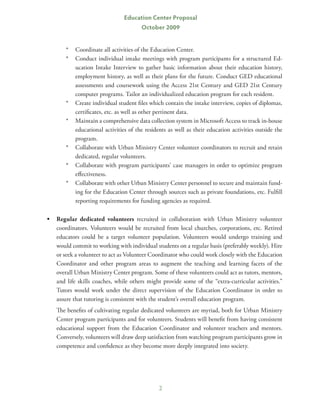

Who Will Staff the Center?
    •	 Education Coordinator - This person would be a regular staff member whose duties would
       consist of the following:


                                                     1
Education Center Proposal
                                       October 2009


       *	 Coordinate all activities of the Education Center.
       *	 Conduct individual intake meetings with program participants for a structured Ed-
          ucation Intake Interview to gather basic information about their education history,
          employment history, as well as their plans for the future. Conduct GED educational
          assessments and coursework using the Access 21st Century and GED 21st Century
          computer programs. Tailor an individualized education program for each resident.
       *	 Create individual student files which contain the intake interview, copies of diplomas,
          certificates, etc. as well as other pertinent data.
       *	 Maintain a comprehensive data collection system in Microsoft Access to track in-house
          educational activities of the residents as well as their education activities outside the
          program.
       *	 Collaborate with Urban Ministry Center volunteer coordinators to recruit and retain
          dedicated, regular volunteers.
       *	 Collaborate with program participants’ case managers in order to optimize program
          effectiveness.
       *	 Collaborate with other Urban Ministry Center personnel to secure and maintain fund-
          ing for the Education Center through sources such as private foundations, etc. Fulfill
          reporting requirements for funding agencies as required.

•	 Regular dedicated volunteers recruited in collaboration with Urban Ministry volunteer
   coordinators. Volunteers would be recruited from local churches, corporations, etc. Retired
   educators could be a target volunteer population. Volunteers would undergo training and
   would commit to working with individual students on a regular basis (preferably weekly). Hire
   or seek a volunteer to act as Volunteer Coordinator who could work closely with the Education
   Coordinator and other program areas to augment the teaching and learning facets of the
   overall Urban Ministry Center program. Some of these volunteers could act as tutors, mentors,
   and life skills coaches, while others might provide some of the “extra-curricular activities.”
   Tutors would work under the direct supervision of the Education Coordinator in order to
   assure that tutoring is consistent with the student’s overall education program.
	   The benefits of cultivating regular dedicated volunteers are myriad, both for Urban Ministry
    Center program participants and for volunteers. Students will benefit from having consistent
    educational support from the Education Coordinator and volunteer teachers and mentors.
    Conversely, volunteers will draw deep satisfaction from watching program participants grow in
    competence and confidence as they become more deeply integrated into society.




                                              2
Education Center Proposal
                                          October 2009

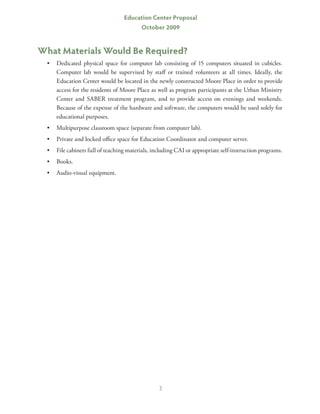

What Materials Would Be Required?
  •	 Dedicated physical space for computer lab consisting of 15 computers situated in cubicles.
     Computer lab would be supervised by staff or trained volunteers at all times. Ideally, the
     Education Center would be located in the newly constructed Moore Place in order to provide
     access for the residents of Moore Place as well as program participants at the Urban Ministry
     Center and SABER treatment program, and to provide access on evenings and weekends.
     Because of the expense of the hardware and software, the computers would be used solely for
     educational purposes.
  •	 Multipurpose classroom space (separate from computer lab).
  •	 Private and locked office space for Education Coordinator and computer server.
  •	 File cabinets full of teaching materials, including CAI or appropriate self-instruction programs.
  •	 Books.
  •	 Audio-visual equipment.




                                                 3
Education Center Proposal
                                           October 2009

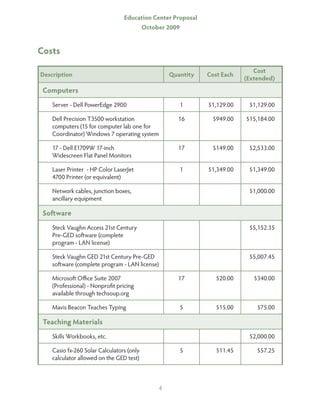

Costs

                                                                              Cost
Description                                         Quantity   Cost Each
                                                                           (Extended)
 Computers
    Server - Dell PowerEdge 2900                       1       $1,129.00    $1,129.00

    Dell Precision T3500 workstation                  16        $949.00    $15,184.00
    computers (15 for computer lab one for
    Coordinator) Windows 7 operating system

    17 - Dell E1709W 17-inch                          17        $149.00     $2,533.00
    Widescreen Flat Panel Monitors

    Laser Printer - HP Color LaserJet                  1       $1,349.00    $1,349.00
    4700 Printer (or equivalent)

    Network cables, junction boxes,                                         $1,000.00
    ancillary equipment

 Software
    Steck Vaughn Access 21st Century                                        $5,152.35
    Pre-GED software (complete
    program - LAN license)

    Steck Vaughn GED 21st Century Pre-GED                                   $5,007.45
    software (complete program - LAN license)

    Microsoft Office Suite 2007                       17          $20.00      $340.00
    (Professional) - Nonprofit pricing
    available through techsoup.org

    Mavis Beacon Teaches Typing                        5          $15.00       $75.00

 Teaching Materials
    Skills Workbooks, etc.                                                  $2,000.00

    Casio fx-260 Solar Calculators (only               5          $11.45       $57.25
    calculator allowed on the GED test)



                                                4
Education Center Proposal
                                         October 2009


                                                                               Cost
Description                                        Quantity     Cost Each
                                                                            (Extended)

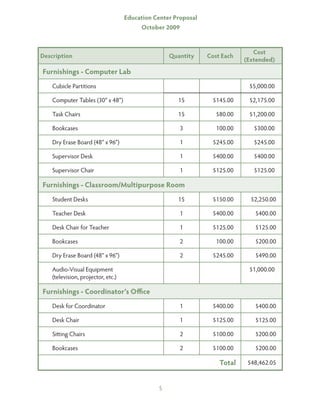

Furnishings - Computer Lab
    Cubicle Partitions                                                       $5,000.00

    Computer Tables (30” x 48”)                       15         $145.00     $2,175.00

    Task Chairs                                       15           $80.00    $1,200.00

    Bookcases                                          3           100.00      $300.00

    Dry Erase Board (48” x 96”)                        1         $245.00       $245.00

    Supervisor Desk                                    1         $400.00       $400.00

    Supervisor Chair                                   1         $125.00       $125.00

Furnishings - Classroom/Multipurpose Room
    Student Desks                                     15         $150.00      $2,250.00

    Teacher Desk                                       1         $400.00       $400.00

    Desk Chair for Teacher                             1         $125.00       $125.00

    Bookcases                                          2           100.00      $200.00

    Dry Erase Board (48” x 96”)                        2         $245.00       $490.00

    Audio-Visual Equipment                                                   $1,000.00
    (television, projector, etc.)

Furnishings - Coordinator’s Office
    Desk for Coordinator                               1         $400.00       $400.00

    Desk Chair                                         1         $125.00       $125.00

    Sitting Chairs                                     2         $100.00       $200.00

    Bookcases                                          2         $100.00       $200.00

                                                                    Total    $48,462.05



                                               5
Education Center Proposal
                                            October 2009

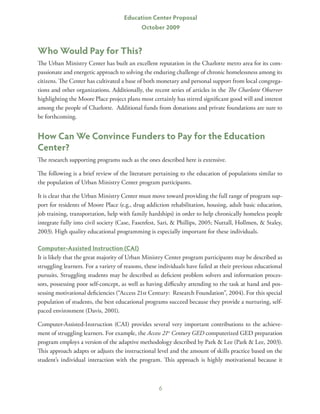

Who Would Pay for This?
The Urban Ministry Center has built an excellent reputation in the Charlotte metro area for its com-
passionate and energetic approach to solving the enduring challenge of chronic homelessness among its
citizens. The Center has cultivated a base of both monetary and personal support from local congrega-
tions and other organizations. Additionally, the recent series of articles in the The Charlotte Observer
highlighting the Moore Place project plans most certainly has stirred significant good will and interest
among the people of Charlotte. Additional funds from donations and private foundations are sure to
be forthcoming.


How Can We Convince Funders to Pay for the Education
Center?
The research supporting programs such as the ones described here is extensive.

The following is a brief review of the literature pertaining to the education of populations similar to
the population of Urban Ministry Center program participants.

It is clear that the Urban Ministry Center must move toward providing the full range of program sup-
port for residents of Moore Place (e.g., drug addiction rehabilitation, housing, adult basic education,
job training, transportation, help with family hardships) in order to help chronically homeless people
integrate fully into civil society (Case, Fasenfest, Sari,  Phillips, 2005; Nuttall, Hollmen,  Staley,
2003). High quality educational programming is especially important for these individuals.

Computer-Assisted Instruction (CAI)
It is likely that the great majority of Urban Ministry Center program participants may be described as
struggling learners. For a variety of reasons, these individuals have failed at their previous educational
pursuits. Struggling students may be described as deficient problem solvers and information proces-
sors, possessing poor self-concept, as well as having difficulty attending to the task at hand and pos-
sessing motivational deficiencies (“Access 21st Century: Research Foundation”, 2004). For this special
population of students, the best educational programs succeed because they provide a nurturing, self-
paced environment (Davis, 2001).

Computer-Assisted-Instruction (CAI) provides several very important contributions to the achieve-
ment of struggling learners. For example, the Access 21st Century GED computerized GED preparation
program employs a version of the adaptive methodology described by Park  Lee (Park  Lee, 2003).
This approach adapts or adjusts the instructional level and the amount of skills practice based on the
student’s individual interaction with the program. This approach is highly motivational because it



                                                    6
Education Center Proposal
                                           October 2009


minimizes student frustration and efficiently manages time on task; this, in turn, leads to improved
outcomes. The sophisticated design of the software allows students to affect their own performance.

Additional positive effects of CAI include achievement effects superior to those obtained with
traditional instruction alone, a faster learning rate, increased time-on-task, and a higher level of
engagement in educational pursuits. Because CAI continually provides students with positive
feedback, it also contributes to improved self-concept (“Access 21st Century: Research Founda-
tion”, 2004).

The hope is that combining the best of positive human interaction with the best instructional technol-
ogy will yield excellent results.

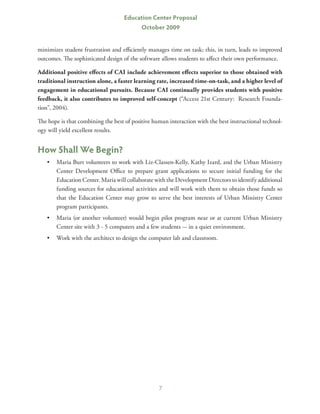

How Shall We Begin?
   •	 Maria Burt volunteers to work with Liz-Classen-Kelly, Kathy Izard, and the Urban Ministry
      Center Development Office to prepare grant applications to secure initial funding for the
      Education Center. Maria will collaborate with the Development Directors to identify additional
      funding sources for educational activities and will work with them to obtain those funds so
      that the Education Center may grow to serve the best interests of Urban Ministry Center
      program participants.
   •	 Maria (or another volunteer) would begin pilot program near or at current Urban Ministry
      Center site with 3 - 5 computers and a few students - in a quiet environment.
   •	 Work with the architect to design the computer lab and classroom.




                                                  7
Education Center Proposal
                                            October 2009


References  Selected Bibliography
The following is a listing of articles containing research applicable to the education of the population
which the Urban Ministry Center serves. I have referenced several of these articles above.


Access 21st Century: Research Foundation [Electronic (2004). Version], 1-3.

Batchelder, J.  Rachel, J. R. (2000). Effects of a Computer-Assisted Instruction Program in a
       Prison Setting: An Experimental Study. Journal of Correctional Education 51(4), 324-332.

Case, P., Fasenfest, D., Sari, R.,  Phillips, A. (2005). Providing Educational Support for Female
        Ex-Inmates: Project PROVE as a Model for Social Reintegration. Journal of Correctional
        Education, 56(2), 146-157.

Davis, H. C. (2001). Educating the Incarcerated Female: An Holistic Approach. Journal of
       Correctional Education, 52(2), 79-83.

Foley, R. M.  Gao, J. (2004). Correctional Education: Characteristics of Academic Programs
        Serving Incarcerated Adults. Journal of Correctional Educations 55(1), 6-21.

Matthews, S. L. (2003). Where Have All the Children Gone: A Glimpse of Students with Special
      Needs in the Prison Classroom. Journal of Correctional Education 54(3), 96-97.

Nuttall, J., Hollmen, L.,  Staley, E. M. (2003). The Effect of Earning a GED on Recidivism Rates.
        Journal of Correctional Education, 54(3), 90-94.

Park, O.  Lee, J. (2003). Adaptive Instructional Systems. In D. H. Jonassen (Ed.), Handbook
       of Research for Educational Communications and Technology (pp. 651-685). Mahwah, NJ:
       Erlbaum.

Paasche-Orlow, M. K., et al. (2005). Educational Attainment but Not Literacy Is Associated with
       HIV Risk Behavior among Incarcerated Women. Journal of Women’s Health 14(9), 852-859.

Rose, Chris (2004). Women’s Participation in Prison Education: What We Know and What We
       Don’t Know. Journal of Correctional Education (55)1, 78-100.

Sabatini, J. P. (2001). Designing Multimedia Learning Systems for Adult Learners: Basic Skills with
       a Workforce Emphasis. National Center on Adult Literacy Working Paper WP00-01.

Schlesinger, R. (2005). Better Myself: Motivation of African Americans to Participate in
        Correctional Education. Journal of Correctional Education 56(3), 228-252.

Steck-Vaughn. The Research Basis for Learning 100® [Electronic Version], 1-12.



                                                   8

Education Center Proposal

  • 1.
    Urban Ministry Center EducationCenter Proposal for Moore Place Submitted by: Maria J. Burt, M.Ed. October 29, 2009
  • 2.
    The Future Future is not some PLACE we are going, but one we are CREATING. the PATHS are not to be found, but MADE. And the activity of making them CHANGES both the MAKERS and their DESTINATION. + John Schaar
  • 3.
    Contents Why Should theUrban Ministry Center Have Its Own Education Center? 1 What Would Be Taught? 1 Who Will Staff the Center? 1 What Materials Would Be Required? 3 Costs 4 Who Would Pay for This? 6 How Can We Convince Funders to Pay for the Education Center? 6 Computer-Assisted Instruction (CAI) 6 How Shall We Begin? 7 References Selected Bibliography 8
  • 4.
    Education Center Proposal October 2009 Why Should the Urban Ministry Center Have Its Own Education Center? To provide Urban Ministry Center program participants with maximum opportunities to increase their educational levels and essential work skills so that the possibility of their job success and integra- tion in society will be improved. The quality of consistent, compassionate relationships between vol- unteer teachers and students will be key. Having educational programs and activities on-site in a safe, supportive, and quietly purposeful environment will greatly increase the probability that program par- ticipants will succeed at their educational endeavors. Additionally, the Education Center will become a focal point for building community among residents, volunteers, and the wider Charlotte community. The addition of an education center will augment the overall success of Moore Place’s mission to pro- vide supportive housing for chronically homeless individuals in the Charlotte area. What Would Be Taught? • Adult Basic Education (ABE) courses, pre-GED and GED preparation courses using Computer-Assisted Instruction (CAI). CAI has been shown to be especially effective with special populations such as chronically homeless individuals. Individual tutoring, formal and informal classroom instruction, writers workshops, etc. would also be provided. • Beginning and advanced computer classes (e.g., basic keyboard skills, introduction to computers, Microsoft Office Suite at all levels). • On a regular basis and in small groups schedule: * field trips * cultural opportunities * sporting activities * cooking classes * crafts classes * household management classes * personal finance classes, including budget and income tax preparation * classes in professional dress and behavior * assistance with legal issues * other topics as they present themselves Who Will Staff the Center? • Education Coordinator - This person would be a regular staff member whose duties would consist of the following: 1
  • 5.
    Education Center Proposal October 2009 * Coordinate all activities of the Education Center. * Conduct individual intake meetings with program participants for a structured Ed- ucation Intake Interview to gather basic information about their education history, employment history, as well as their plans for the future. Conduct GED educational assessments and coursework using the Access 21st Century and GED 21st Century computer programs. Tailor an individualized education program for each resident. * Create individual student files which contain the intake interview, copies of diplomas, certificates, etc. as well as other pertinent data. * Maintain a comprehensive data collection system in Microsoft Access to track in-house educational activities of the residents as well as their education activities outside the program. * Collaborate with Urban Ministry Center volunteer coordinators to recruit and retain dedicated, regular volunteers. * Collaborate with program participants’ case managers in order to optimize program effectiveness. * Collaborate with other Urban Ministry Center personnel to secure and maintain fund- ing for the Education Center through sources such as private foundations, etc. Fulfill reporting requirements for funding agencies as required. • Regular dedicated volunteers recruited in collaboration with Urban Ministry volunteer coordinators. Volunteers would be recruited from local churches, corporations, etc. Retired educators could be a target volunteer population. Volunteers would undergo training and would commit to working with individual students on a regular basis (preferably weekly). Hire or seek a volunteer to act as Volunteer Coordinator who could work closely with the Education Coordinator and other program areas to augment the teaching and learning facets of the overall Urban Ministry Center program. Some of these volunteers could act as tutors, mentors, and life skills coaches, while others might provide some of the “extra-curricular activities.” Tutors would work under the direct supervision of the Education Coordinator in order to assure that tutoring is consistent with the student’s overall education program. The benefits of cultivating regular dedicated volunteers are myriad, both for Urban Ministry Center program participants and for volunteers. Students will benefit from having consistent educational support from the Education Coordinator and volunteer teachers and mentors. Conversely, volunteers will draw deep satisfaction from watching program participants grow in competence and confidence as they become more deeply integrated into society. 2
  • 6.
    Education Center Proposal October 2009 What Materials Would Be Required? • Dedicated physical space for computer lab consisting of 15 computers situated in cubicles. Computer lab would be supervised by staff or trained volunteers at all times. Ideally, the Education Center would be located in the newly constructed Moore Place in order to provide access for the residents of Moore Place as well as program participants at the Urban Ministry Center and SABER treatment program, and to provide access on evenings and weekends. Because of the expense of the hardware and software, the computers would be used solely for educational purposes. • Multipurpose classroom space (separate from computer lab). • Private and locked office space for Education Coordinator and computer server. • File cabinets full of teaching materials, including CAI or appropriate self-instruction programs. • Books. • Audio-visual equipment. 3
  • 7.
    Education Center Proposal October 2009 Costs Cost Description Quantity Cost Each (Extended) Computers Server - Dell PowerEdge 2900 1 $1,129.00 $1,129.00 Dell Precision T3500 workstation 16 $949.00 $15,184.00 computers (15 for computer lab one for Coordinator) Windows 7 operating system 17 - Dell E1709W 17-inch 17 $149.00 $2,533.00 Widescreen Flat Panel Monitors Laser Printer - HP Color LaserJet 1 $1,349.00 $1,349.00 4700 Printer (or equivalent) Network cables, junction boxes, $1,000.00 ancillary equipment Software Steck Vaughn Access 21st Century $5,152.35 Pre-GED software (complete program - LAN license) Steck Vaughn GED 21st Century Pre-GED $5,007.45 software (complete program - LAN license) Microsoft Office Suite 2007 17 $20.00 $340.00 (Professional) - Nonprofit pricing available through techsoup.org Mavis Beacon Teaches Typing 5 $15.00 $75.00 Teaching Materials Skills Workbooks, etc. $2,000.00 Casio fx-260 Solar Calculators (only 5 $11.45 $57.25 calculator allowed on the GED test) 4
  • 8.
    Education Center Proposal October 2009 Cost Description Quantity Cost Each (Extended) Furnishings - Computer Lab Cubicle Partitions $5,000.00 Computer Tables (30” x 48”) 15 $145.00 $2,175.00 Task Chairs 15 $80.00 $1,200.00 Bookcases 3 100.00 $300.00 Dry Erase Board (48” x 96”) 1 $245.00 $245.00 Supervisor Desk 1 $400.00 $400.00 Supervisor Chair 1 $125.00 $125.00 Furnishings - Classroom/Multipurpose Room Student Desks 15 $150.00 $2,250.00 Teacher Desk 1 $400.00 $400.00 Desk Chair for Teacher 1 $125.00 $125.00 Bookcases 2 100.00 $200.00 Dry Erase Board (48” x 96”) 2 $245.00 $490.00 Audio-Visual Equipment $1,000.00 (television, projector, etc.) Furnishings - Coordinator’s Office Desk for Coordinator 1 $400.00 $400.00 Desk Chair 1 $125.00 $125.00 Sitting Chairs 2 $100.00 $200.00 Bookcases 2 $100.00 $200.00 Total $48,462.05 5
  • 9.
    Education Center Proposal October 2009 Who Would Pay for This? The Urban Ministry Center has built an excellent reputation in the Charlotte metro area for its com- passionate and energetic approach to solving the enduring challenge of chronic homelessness among its citizens. The Center has cultivated a base of both monetary and personal support from local congrega- tions and other organizations. Additionally, the recent series of articles in the The Charlotte Observer highlighting the Moore Place project plans most certainly has stirred significant good will and interest among the people of Charlotte. Additional funds from donations and private foundations are sure to be forthcoming. How Can We Convince Funders to Pay for the Education Center? The research supporting programs such as the ones described here is extensive. The following is a brief review of the literature pertaining to the education of populations similar to the population of Urban Ministry Center program participants. It is clear that the Urban Ministry Center must move toward providing the full range of program sup- port for residents of Moore Place (e.g., drug addiction rehabilitation, housing, adult basic education, job training, transportation, help with family hardships) in order to help chronically homeless people integrate fully into civil society (Case, Fasenfest, Sari, Phillips, 2005; Nuttall, Hollmen, Staley, 2003). High quality educational programming is especially important for these individuals. Computer-Assisted Instruction (CAI) It is likely that the great majority of Urban Ministry Center program participants may be described as struggling learners. For a variety of reasons, these individuals have failed at their previous educational pursuits. Struggling students may be described as deficient problem solvers and information proces- sors, possessing poor self-concept, as well as having difficulty attending to the task at hand and pos- sessing motivational deficiencies (“Access 21st Century: Research Foundation”, 2004). For this special population of students, the best educational programs succeed because they provide a nurturing, self- paced environment (Davis, 2001). Computer-Assisted-Instruction (CAI) provides several very important contributions to the achieve- ment of struggling learners. For example, the Access 21st Century GED computerized GED preparation program employs a version of the adaptive methodology described by Park Lee (Park Lee, 2003). This approach adapts or adjusts the instructional level and the amount of skills practice based on the student’s individual interaction with the program. This approach is highly motivational because it 6
  • 10.
    Education Center Proposal October 2009 minimizes student frustration and efficiently manages time on task; this, in turn, leads to improved outcomes. The sophisticated design of the software allows students to affect their own performance. Additional positive effects of CAI include achievement effects superior to those obtained with traditional instruction alone, a faster learning rate, increased time-on-task, and a higher level of engagement in educational pursuits. Because CAI continually provides students with positive feedback, it also contributes to improved self-concept (“Access 21st Century: Research Founda- tion”, 2004). The hope is that combining the best of positive human interaction with the best instructional technol- ogy will yield excellent results. How Shall We Begin? • Maria Burt volunteers to work with Liz-Classen-Kelly, Kathy Izard, and the Urban Ministry Center Development Office to prepare grant applications to secure initial funding for the Education Center. Maria will collaborate with the Development Directors to identify additional funding sources for educational activities and will work with them to obtain those funds so that the Education Center may grow to serve the best interests of Urban Ministry Center program participants. • Maria (or another volunteer) would begin pilot program near or at current Urban Ministry Center site with 3 - 5 computers and a few students - in a quiet environment. • Work with the architect to design the computer lab and classroom. 7
  • 11.
    Education Center Proposal October 2009 References Selected Bibliography The following is a listing of articles containing research applicable to the education of the population which the Urban Ministry Center serves. I have referenced several of these articles above. Access 21st Century: Research Foundation [Electronic (2004). Version], 1-3. Batchelder, J. Rachel, J. R. (2000). Effects of a Computer-Assisted Instruction Program in a Prison Setting: An Experimental Study. Journal of Correctional Education 51(4), 324-332. Case, P., Fasenfest, D., Sari, R., Phillips, A. (2005). Providing Educational Support for Female Ex-Inmates: Project PROVE as a Model for Social Reintegration. Journal of Correctional Education, 56(2), 146-157. Davis, H. C. (2001). Educating the Incarcerated Female: An Holistic Approach. Journal of Correctional Education, 52(2), 79-83. Foley, R. M. Gao, J. (2004). Correctional Education: Characteristics of Academic Programs Serving Incarcerated Adults. Journal of Correctional Educations 55(1), 6-21. Matthews, S. L. (2003). Where Have All the Children Gone: A Glimpse of Students with Special Needs in the Prison Classroom. Journal of Correctional Education 54(3), 96-97. Nuttall, J., Hollmen, L., Staley, E. M. (2003). The Effect of Earning a GED on Recidivism Rates. Journal of Correctional Education, 54(3), 90-94. Park, O. Lee, J. (2003). Adaptive Instructional Systems. In D. H. Jonassen (Ed.), Handbook of Research for Educational Communications and Technology (pp. 651-685). Mahwah, NJ: Erlbaum. Paasche-Orlow, M. K., et al. (2005). Educational Attainment but Not Literacy Is Associated with HIV Risk Behavior among Incarcerated Women. Journal of Women’s Health 14(9), 852-859. Rose, Chris (2004). Women’s Participation in Prison Education: What We Know and What We Don’t Know. Journal of Correctional Education (55)1, 78-100. Sabatini, J. P. (2001). Designing Multimedia Learning Systems for Adult Learners: Basic Skills with a Workforce Emphasis. National Center on Adult Literacy Working Paper WP00-01. Schlesinger, R. (2005). Better Myself: Motivation of African Americans to Participate in Correctional Education. Journal of Correctional Education 56(3), 228-252. Steck-Vaughn. The Research Basis for Learning 100® [Electronic Version], 1-12. 8
