The document discusses four main methods for dewatering excavations at construction sites:

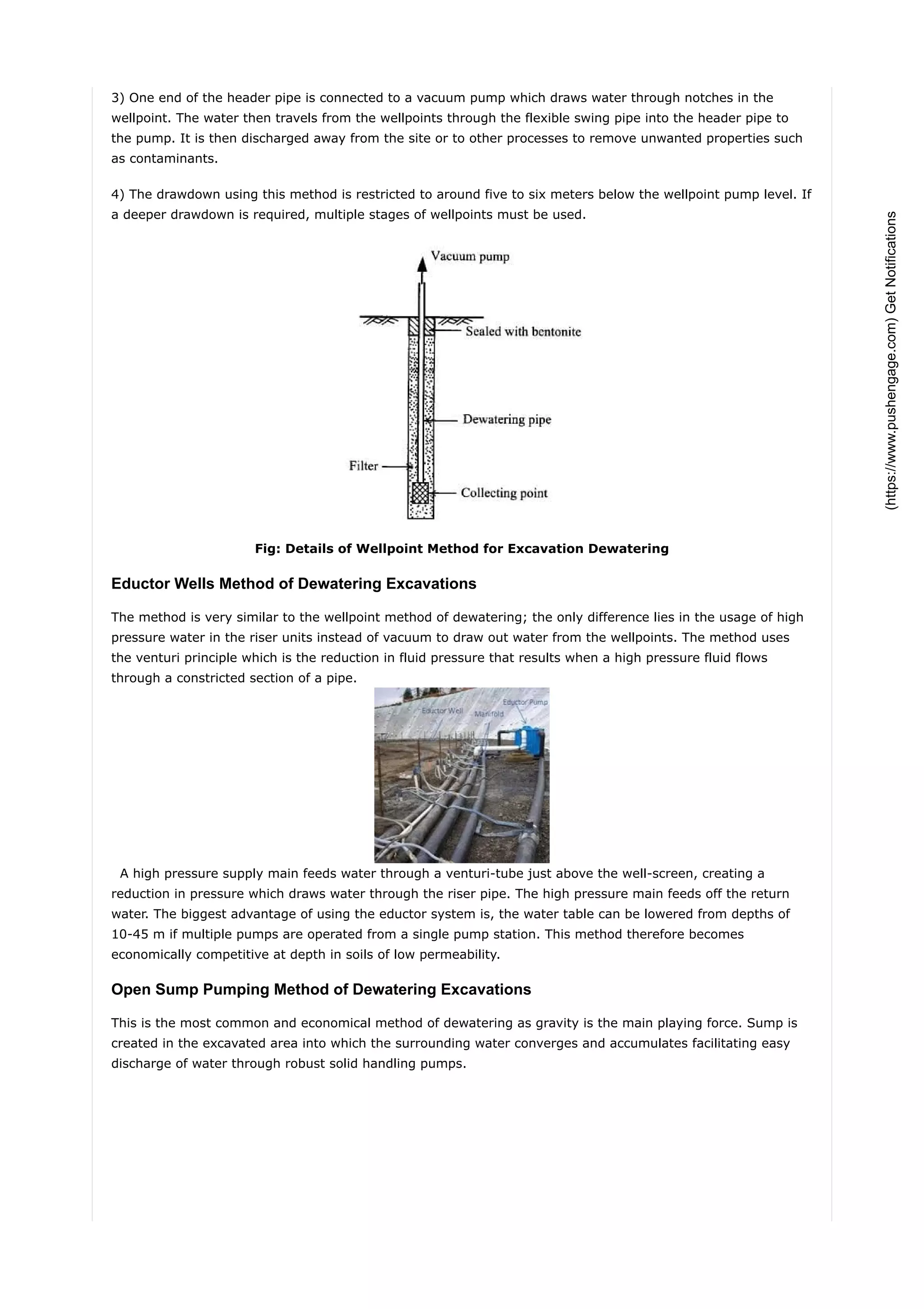

1. The wellpoint method uses a series of wells and pumps to lower the water table up to 5-6 meters below the wells.
2. The eductor wells method is similar but uses high pressure water and venturi tubes instead of vacuum pumps to draw water from the wells.

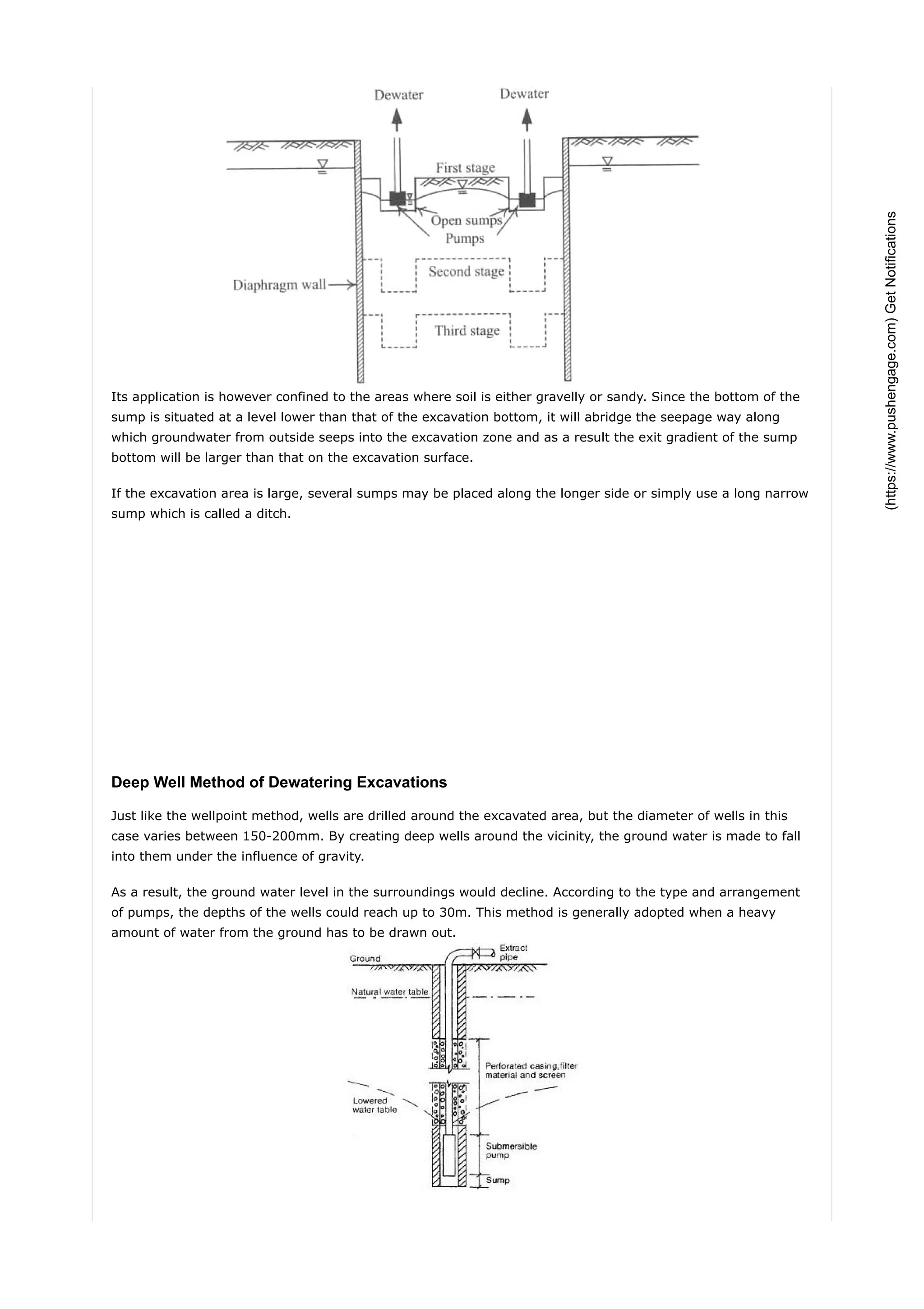

3. Open sump pumping relies on gravity, using sumps or ditches to collect water for removal by pumps.
4. The deep well method uses deeper wells 150-200mm in diameter surrounded by casings and screens to draw water down by up to 30 meters.
