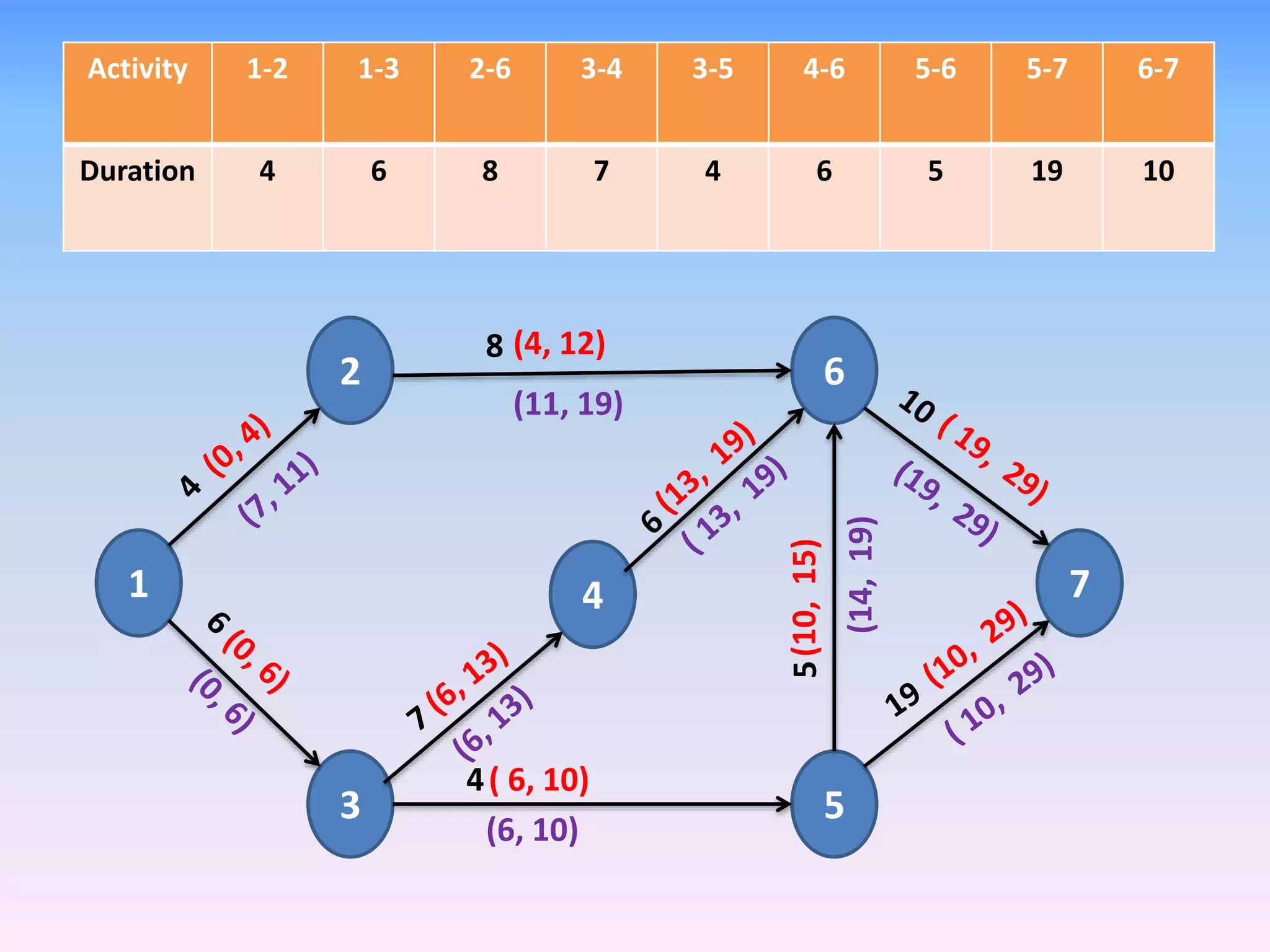

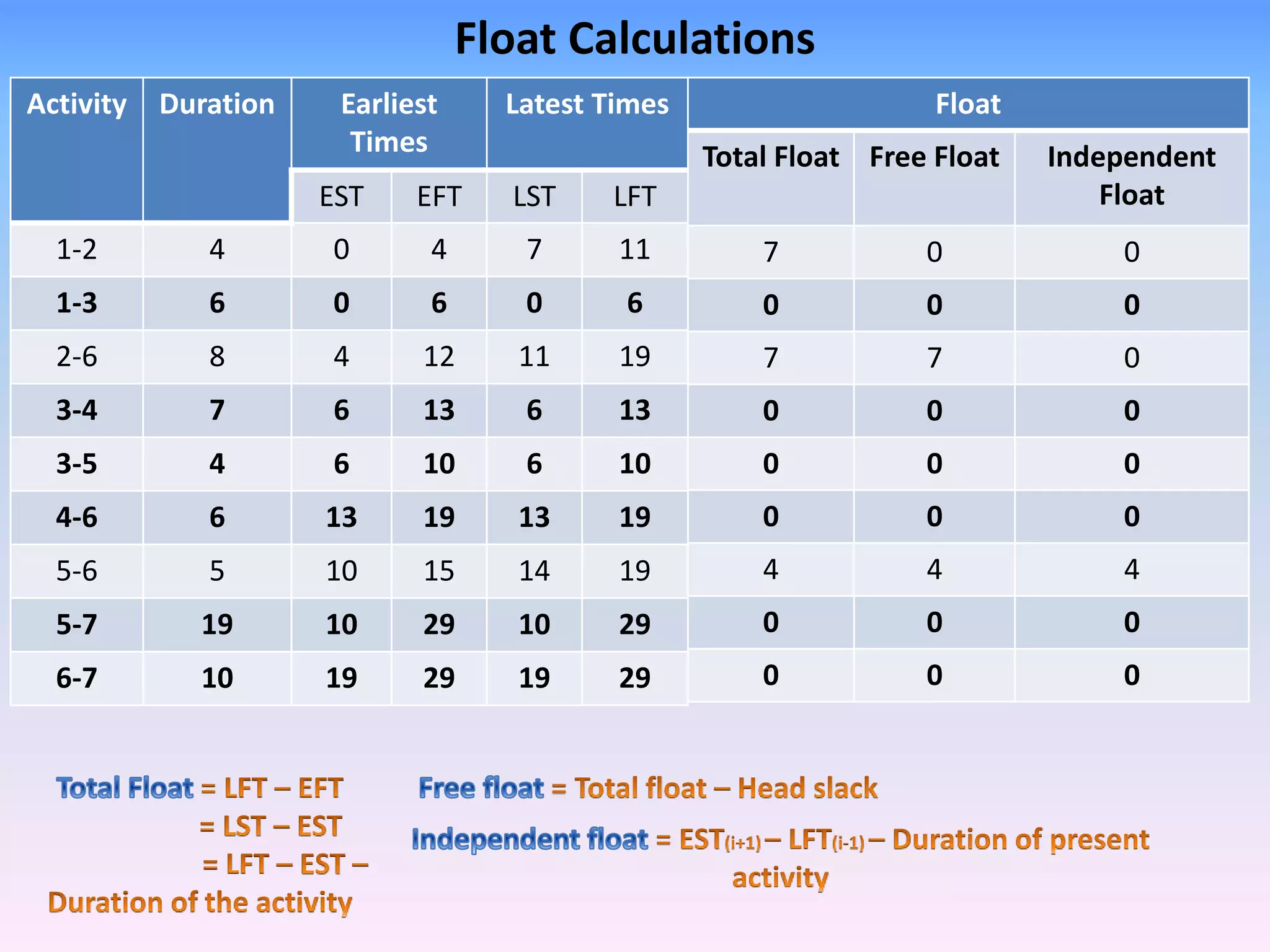

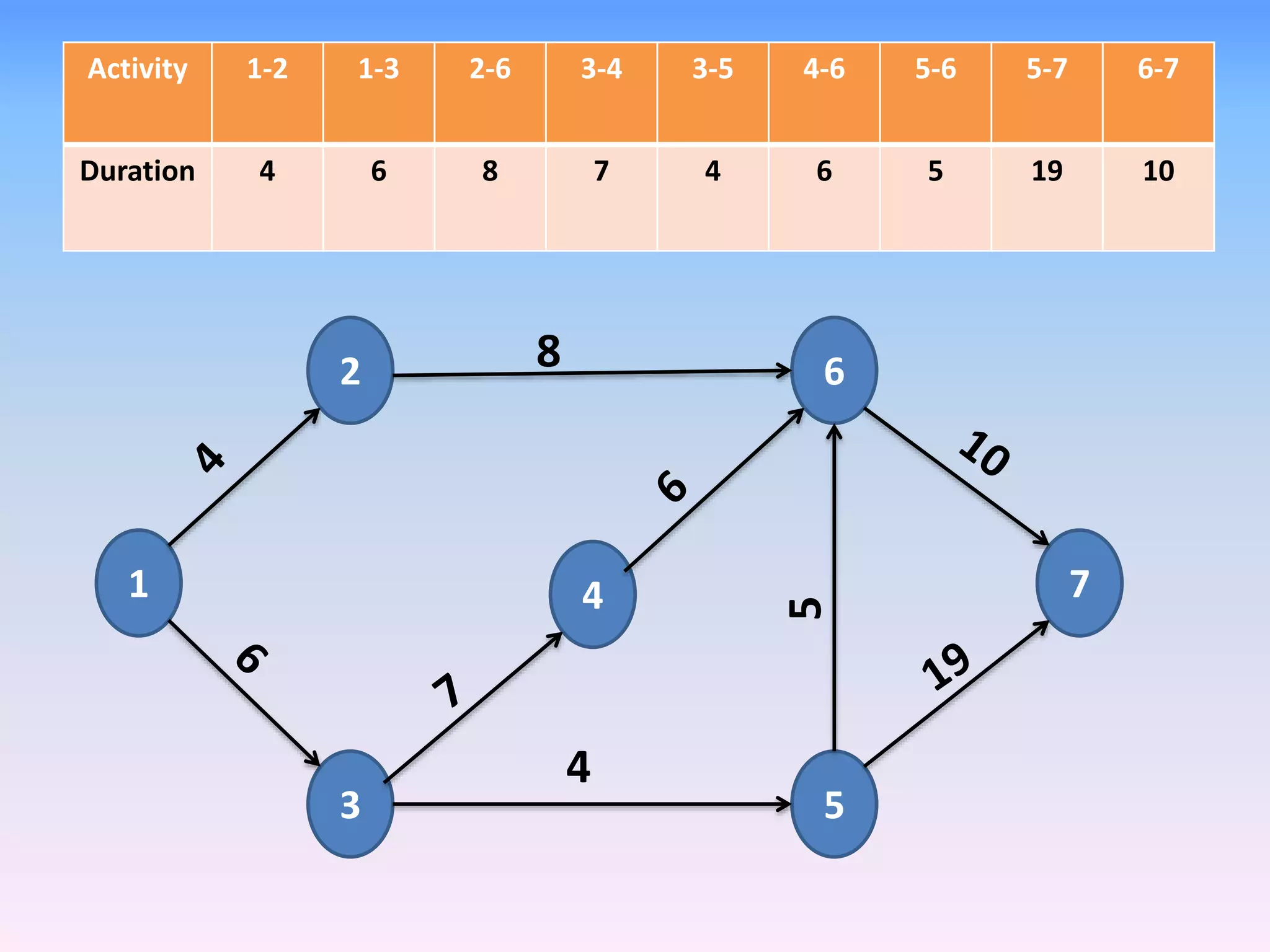

The document outlines a project network with various activities, their durations, and associated critical paths. The critical activities include paths such as 1-3-4-6-7 and 1-3-5-7, with total durations of 29 and 25 respectively. The float calculations show the earliest and latest times for activities, revealing a total float of 7 for certain tasks.
