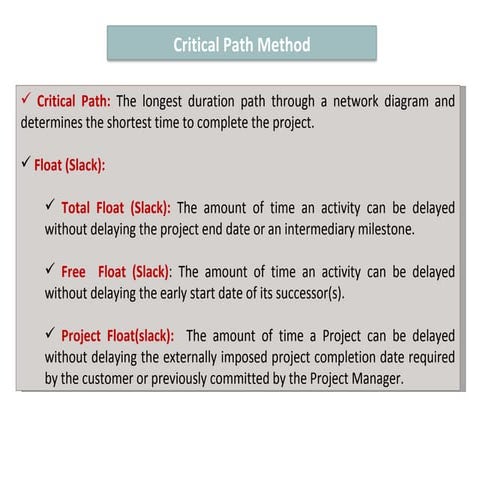

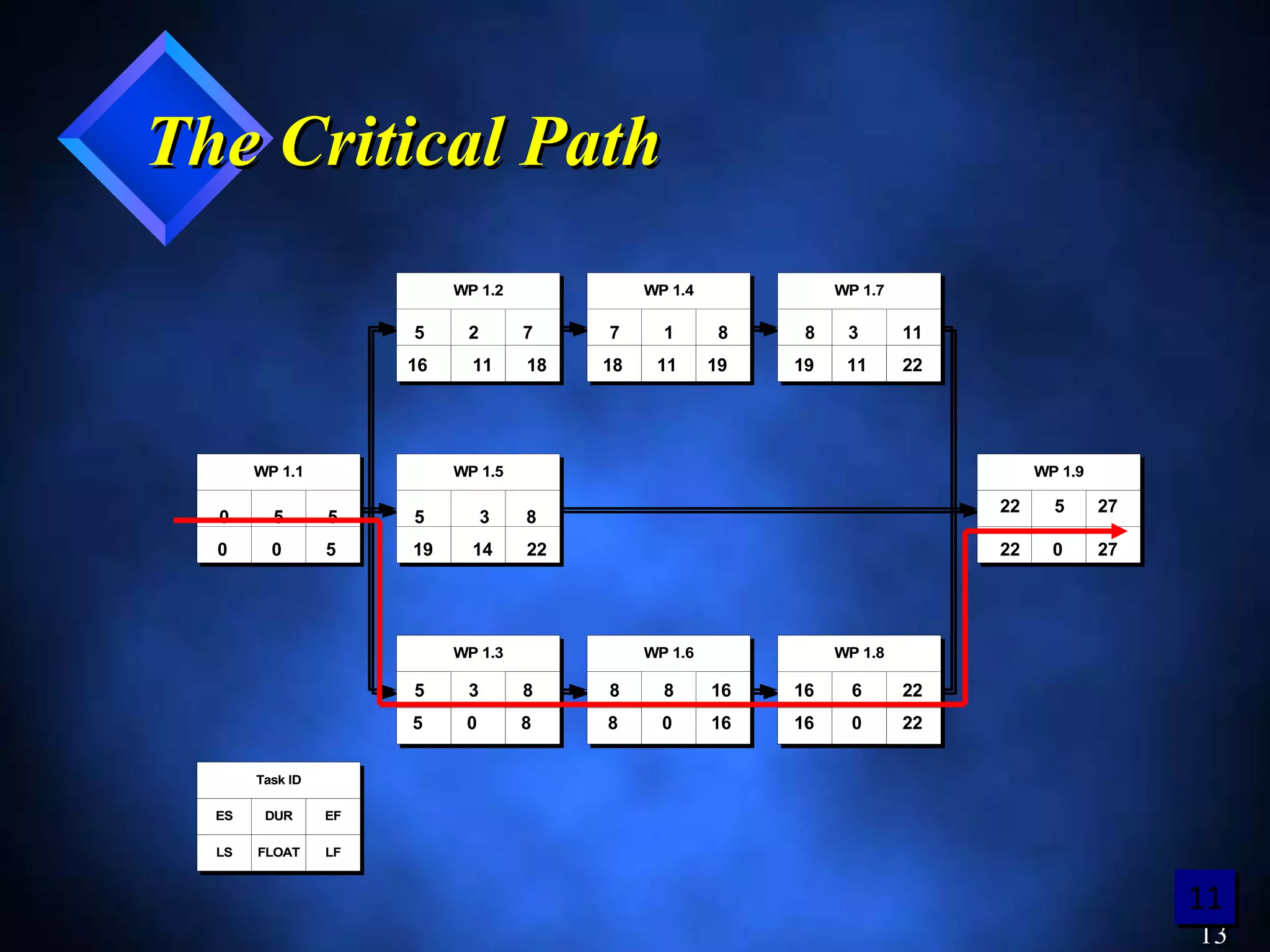

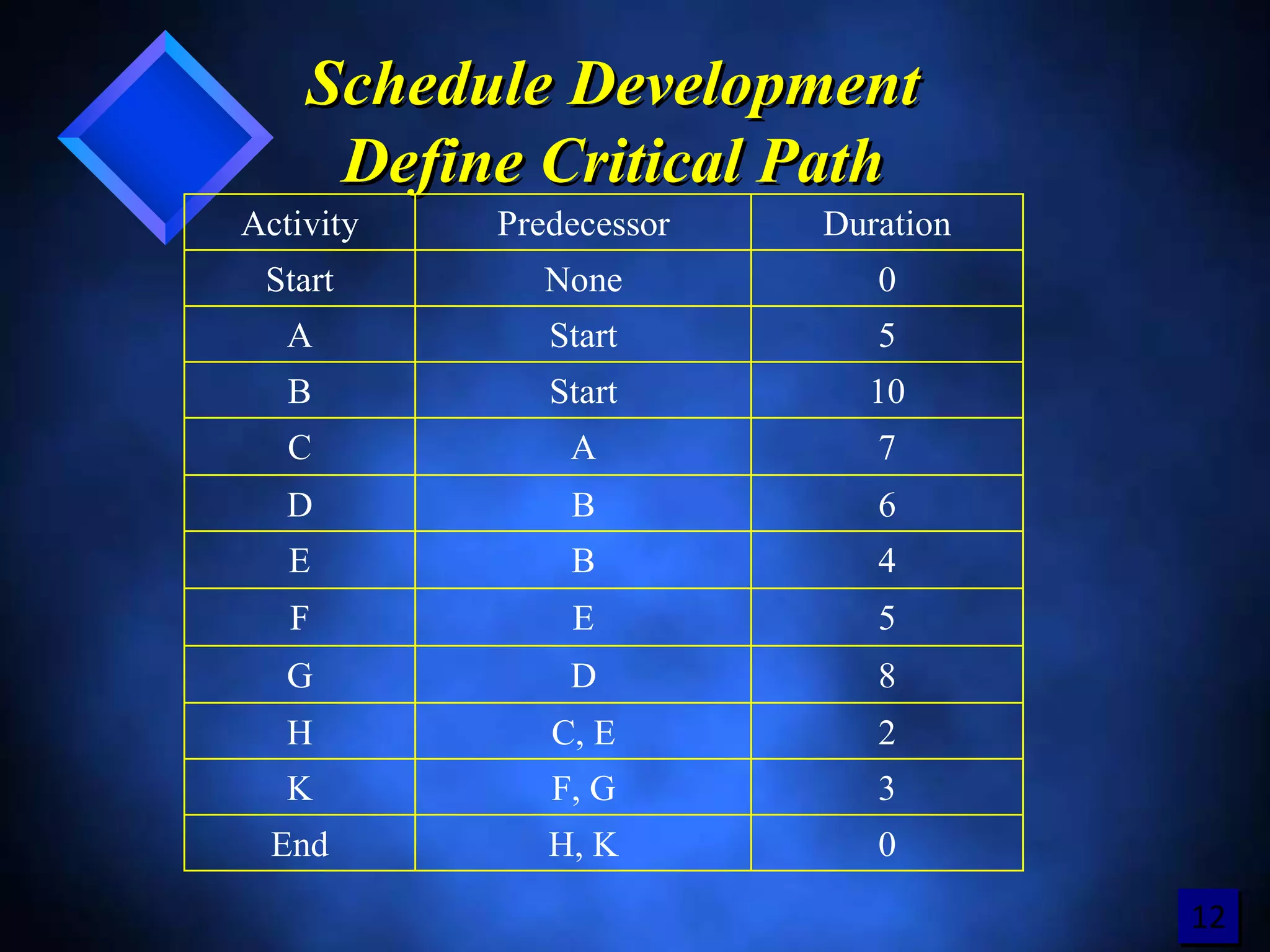

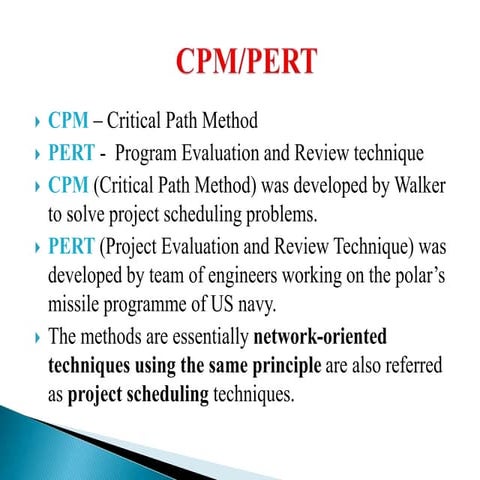

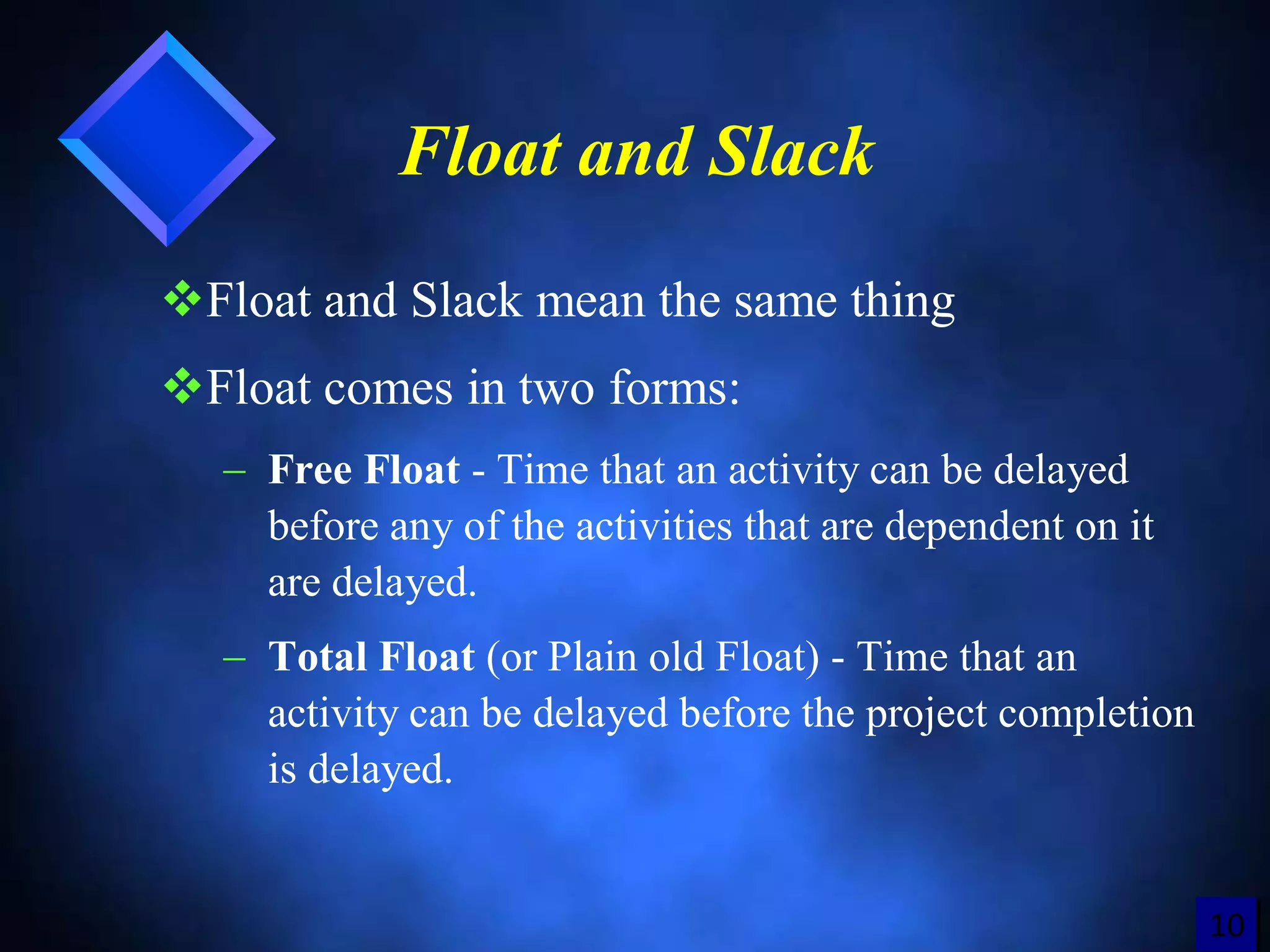

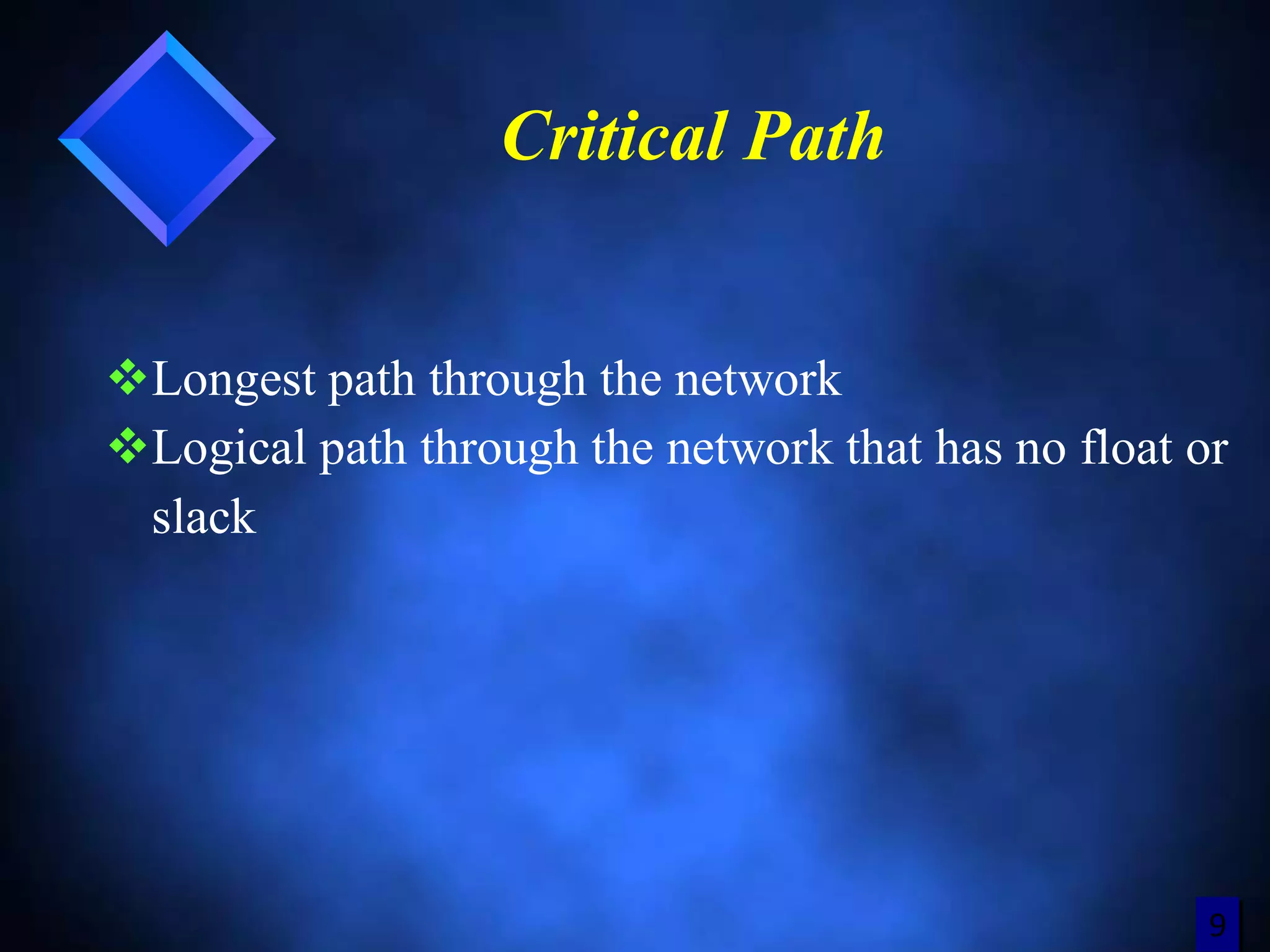

The document outlines project scheduling details, focusing on activity durations, early and late start/finish times, and cost estimations for various tasks. It also discusses the critical path method, including the concepts of float and slack, highlighting their significance in project management. Additionally, it provides instructions for calculating early/late dates and determining the critical path through network diagrams.
