Procurement (CONS6817) Lara Tookey
PROCUREMENT – SESSION #4
Evaluation of Management variations.
Contract Types
Procurement (CONS6817) Lara TookeyOur focus for the course
Procurement (CONS6817) Lara Tookey

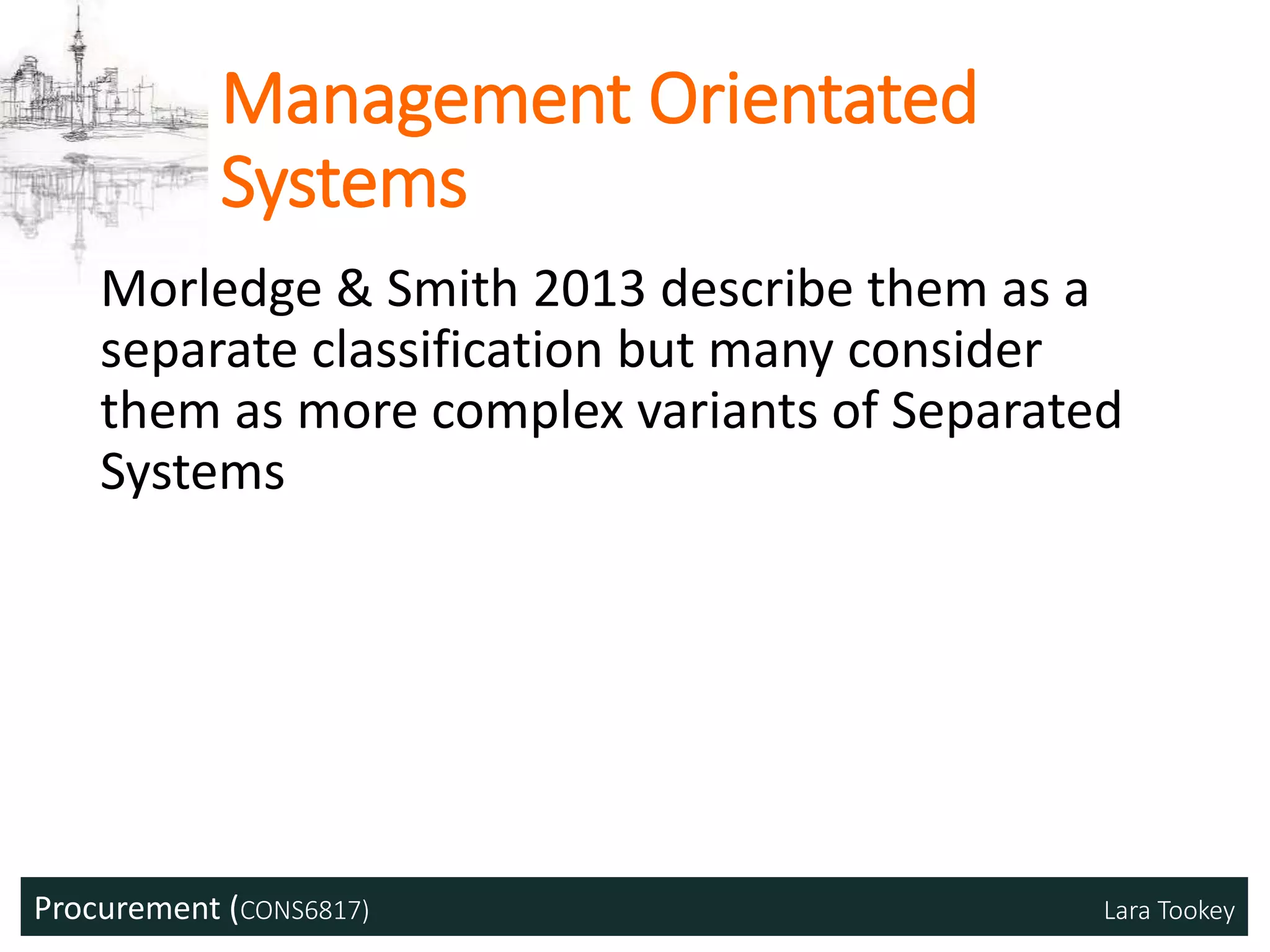

Management Orientated
Systems
Morledge & Smith 2013 describe them as a
separate classification but many consider
them as more complex variants of Separated
Systems
Procurement (CONS6817) Lara Tookey

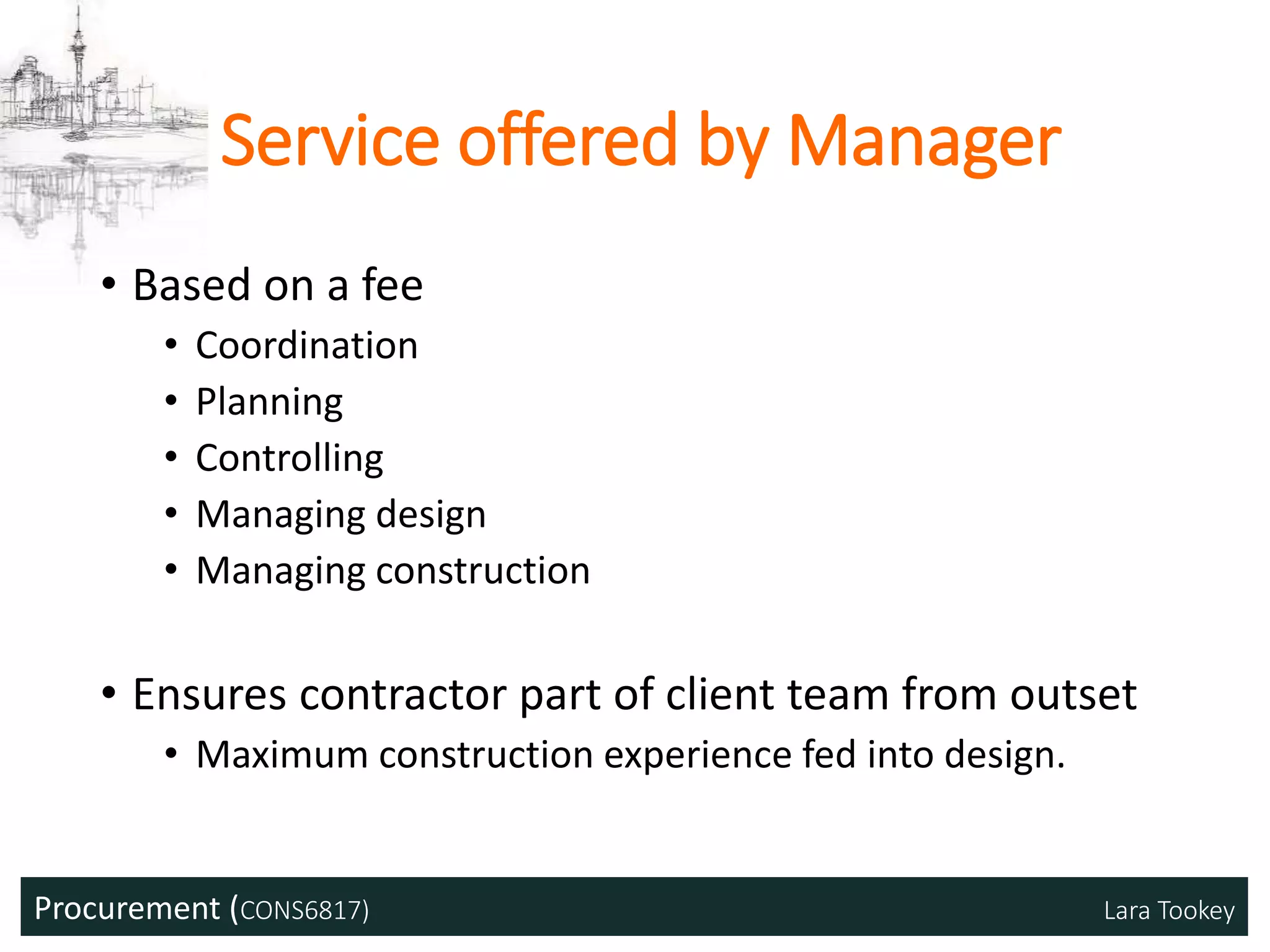

Service offered by Manager
• Based on a fee
• Coordination
• Planning
• Controlling
• Managing design
• Managing construction
• Ensures contractor part of client team from outset
• Maximum construction experience fed into design.
Procurement (CONS6817) Lara Tookey
Used when…..
• Project is large & complex
• Fast-track procurement required
• Client wishes to select designer separately
• Often a result of a competition
• Work is not sufficiently designed prior to
construction
• Design and technology designed in tandem
Procurement (CONS6817) Lara Tookey
Used when…..
• Project is organisationally complex
• Flexibility is required throughout
• Less adversarial approach is preferred
• Choice of competitive tendering for each element
is preferred
• Target price rather than fixed lump sum accepted.
Procurement (CONS6817) Lara Tookey
Using Management
Orientated Systems to get
better integration between
design and construction
Procurement (CONS6817) Lara Tookey

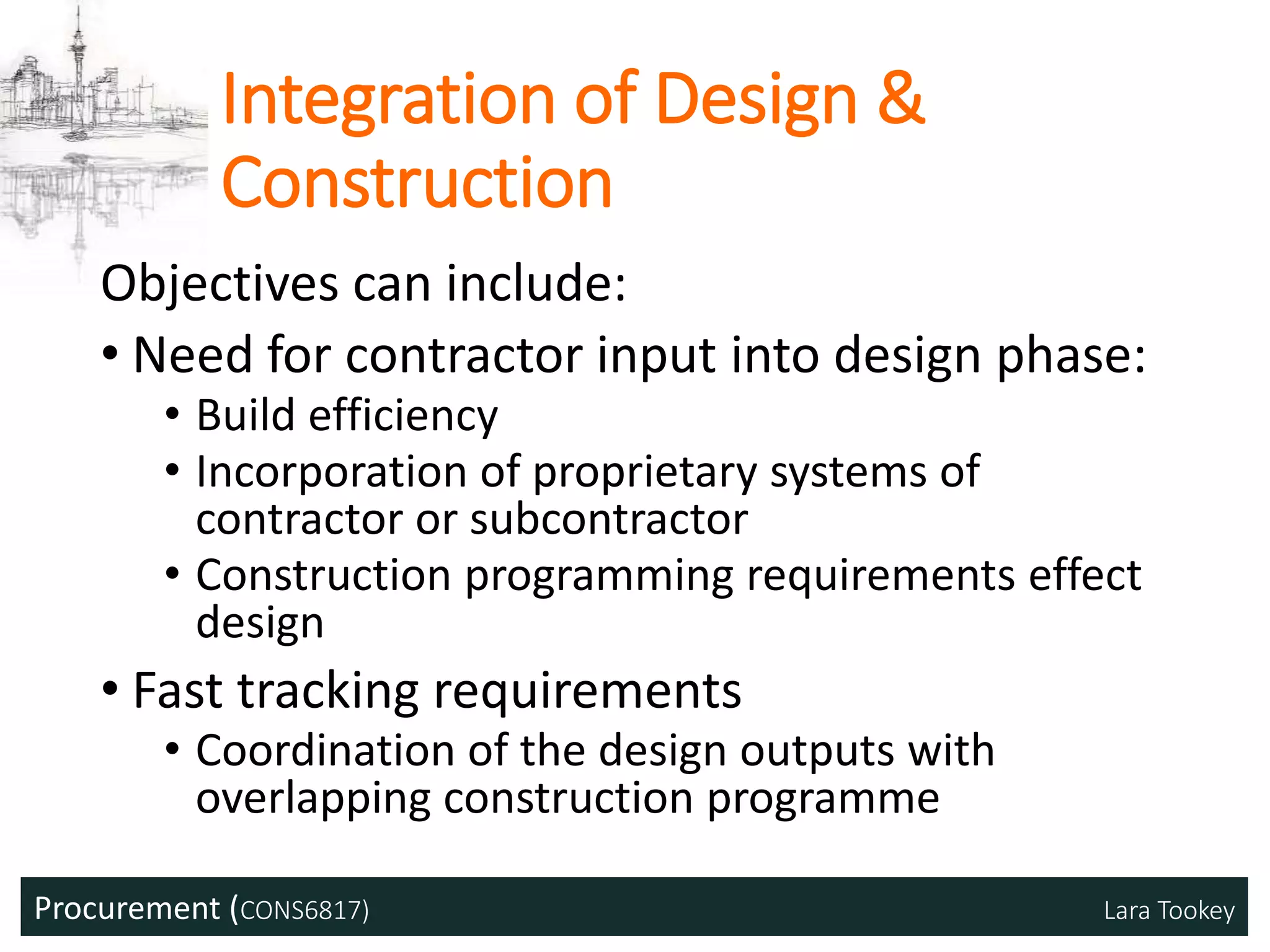

Integration of Design &
Construction
Objectives can include:
• Need for contractor input into design phase:
• Build efficiency
• Incorporation of proprietary systems of
contractor or subcontractor
• Construction programming requirements effect
design
• Fast tracking requirements
• Coordination of the design outputs with
overlapping construction programme
Procurement (CONS6817) Lara Tookey
Management
Orientated
Procurement
Options
Construction
Management
Management
Contracting
Design &
Manage
Procurement (CONS6817) Lara Tookey
Management contracting
• A management contractor undertakes to perform the
works through trade contractors who are
contractually accountable to the management
contractor.
• Does not undertake the work themselves
• Strictly MANAGEMENT
• However, the management contractor is not strictly
liable for the consequences of any default by trade
contractors – as long as the management contractor
has complied with its management obligation
(generally a skill and care obligation) under the
management contract.
Procurement (CONS6817) Lara Tookey
The Process
• C employs A/E to produce outline design
• MC companies can bid for work
• Best “overall submission” should win
• Fee, management, programme, track record etc.
• Winning contractor joins team
• Advises designers in completion of design, organises construction
in parallel by employing “works package contractors”
• Contractor appointed at early stage and works for a fee
• Fee can be a %
• Can incorporate a GMP
• Fee can be a bid
• Client pays COST of packages + fee on monthly basis
Procurement (CONS6817) Lara Tookey
• Probity issues can be covered
• Sub-contractors normally appointed by an ‘open
book’ bid process
Procurement (CONS6817) Lara Tookey
Construction management
• Owners engage construction managers (CMs) to
assist in developing bid documents and overseeing
project construction.
• CM:
• Is a professional or a firm trained in the management of
construction processes.
• Is generally interposed between the owner and some or
all of the other participants.
Procurement (CONS6817) Lara Tookey
There are two general types of
CM:
• Agency Construction Managers (ACM)
• Aka Construction Manager as Adviser (CMa)
• Construction managers-at-risk (CMr)
• Aka Construction Manager as Constructor (CMc)
Procurement (CONS6817) Lara Tookey
Construction Manager as
Adviser
• CMa acts as an agent of the owner and extends the
owner’s internal capabilities in performing
traditional owner responsibilities.
• The level of service by the CMa can range from on-
call advice to full project management.
Procurement (CONS6817) Lara Tookey
Construction Manager as
Adviser
• In some cases, the owner hires the CMa before
design begins and CMa may participate in the
selection of and contracting with the designer or
might even be the designer.
Procurement (CONS6817) Lara Tookey
Construction Manager as
Adviser
• O retains A and CM who acts as an independent
adviser to the owner.
• Prime contractor(s) responsible for construction,
labour and materials.
• CM gives O construction management advice
through design and construction phase.
• Increases expertise in managing a project from start to
finish.
Procurement (CONS6817) Lara Tookey
Construction Manager as Adviser
(CMa)
Contract Relationship
Owner
Consultant
Architect
Const. Manager
Adviser (CMa)
Consultant
Contractor Contractor
Sub-
contractor
Sub-
contractor
Multiple prime contractors
Procurement (CONS6817) Lara Tookey
What is Multi-prime CM?
• Several specialty contractors are engaged to do
specific portions of the work
• Each contractor has a direct contract with the
owner
• Breakdown of work may be by phase, by trade, or
both
• Each prime contractor may also have
subcontractors
• Work is managed for the owner by a CMa firm
Procurement (CONS6817) Lara Tookey
Construction Manager as
Constructor (CMc)/(CMr)
• Single party (Construction Manager) provides
construction management services in pre-
construction phase AND then completes
construction.
• Gives CM Constructor responsibility and control
over construction work via direct contracts with
sub-contractors.
Procurement (CONS6817) Lara Tookey
Construction Manager as
Constructor (CMc) aka
Owner
Consultant
Architect
Const. Manager
Constructor (CMc)
Consultant
Sub-
contractor
Sub-
contractor
Construction Manager at Risk (CMr)
Procurement (CONS6817) Lara Tookey
CM(r) typically contracts with
the owner in two stages.
• First, CMr manages and undertakes services during
conceptual & preliminary design phases with the
design professional.
• When design is complete, owner and CMr then
agree on a price and schedule for the completion of
the construction work.
Procurement (CONS6817) Lara Tookey
Design & Manage
Similar to the previous, except the design consultant manages
the work package contractors.
Procurement (CONS6817) Lara Tookey
CONTRACT TYPES
3910 - Conditions of contract for building and civil engineering
3916 - Conditions of contract for building and civil engineering – Design & Construct
3917 – Conditions of contract for building and civil engineering – Fixed Term
Procurement (CONS6817) Lara Tookey

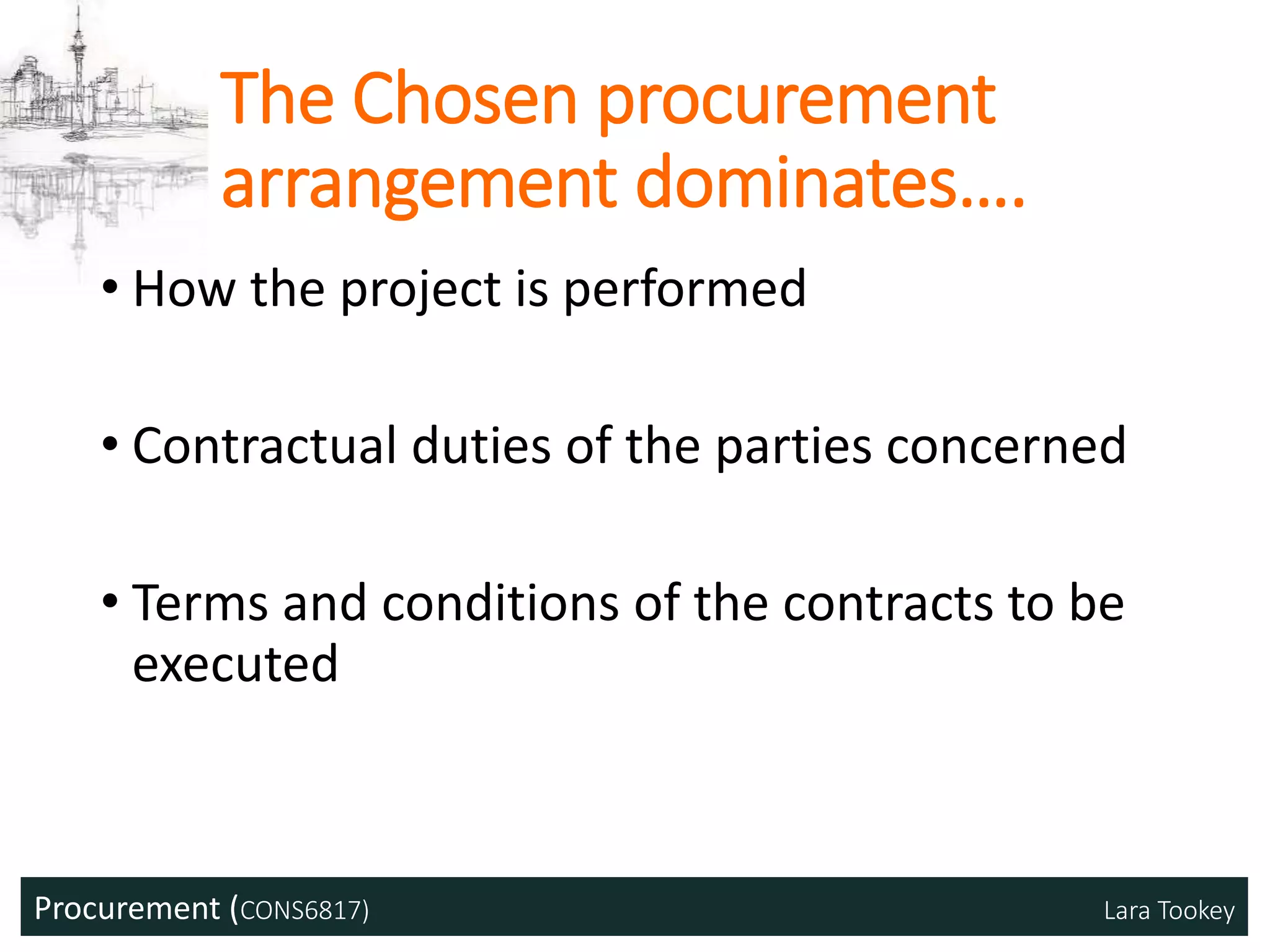

The Chosen procurement
arrangement dominates….
• How the project is performed
• Contractual duties of the parties concerned
• Terms and conditions of the contracts to be
executed
Procurement (CONS6817) Lara Tookey
Construction contracts
• A construction contract is a mutually legally
binding agreement that gives rights and
places obligations on both parties
• obligates the seller to provide specified products
or services,
• and obligates the buyer to pay for them.
Procurement (CONS6817) Lara Tookey
Client
• Rights:
• To receive the work specified at the time and for
the price specified.
• Obligations:
• To hand over the site
• To provide required information
• Not to impede the progress of the work
• To pay as agreed
Procurement (CONS6817) Lara Tookey
Contractor
• Rights
• To be given possession of the site
• To control their operations as they see fit
• To receive necessary information in good time
• To be paid as agreed
• Obligations
• To carry out the work as specified
• To take instructions from the client’s
representative
• To deliver at the agreed time
Procurement (CONS6817) Lara Tookey

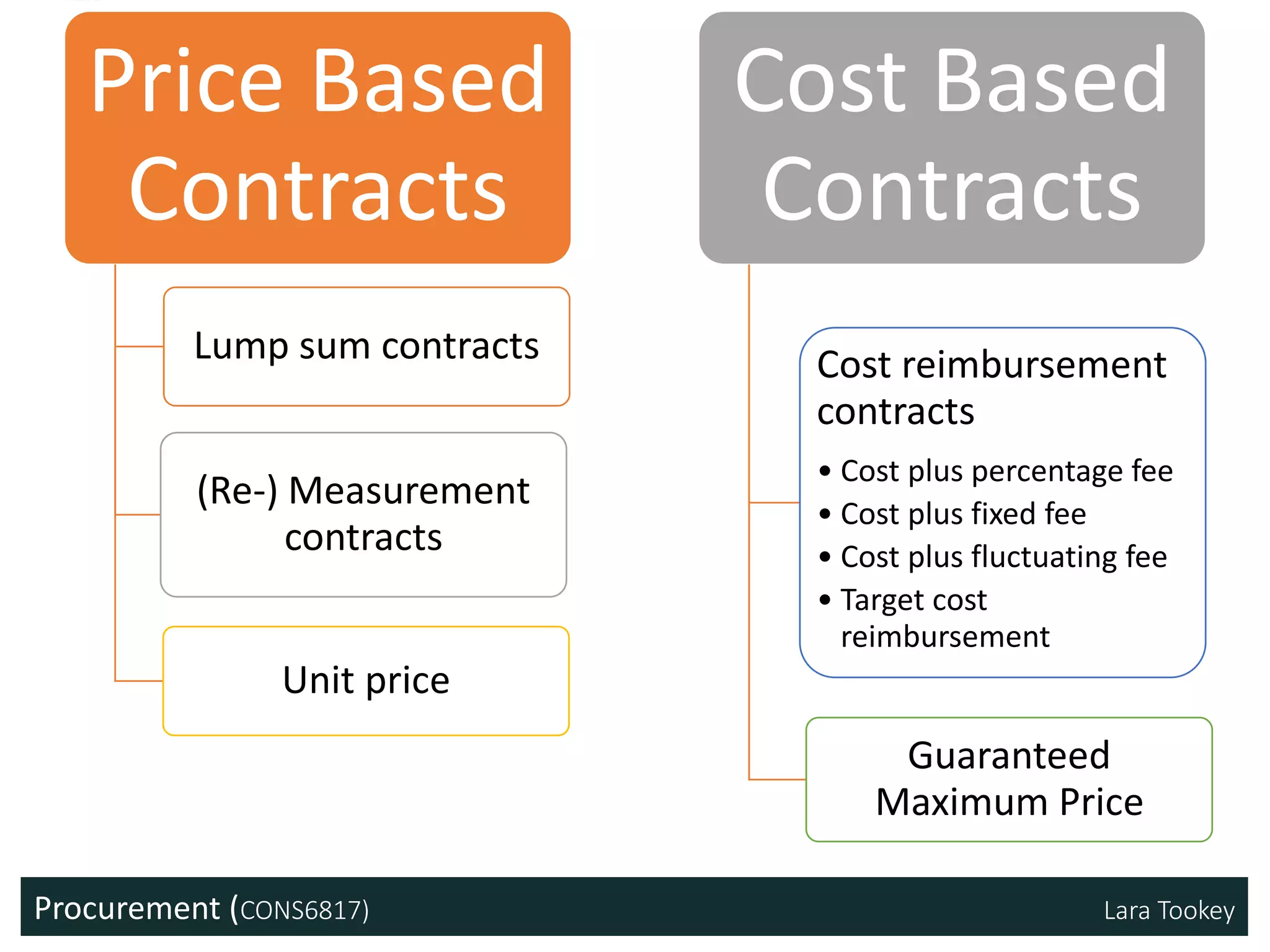

PRICE MECHANISMS IN CONTRACTS
Procurement (CONS6817) Lara Tookey
Price Based
Contracts
Lump sum contracts
(Re-) Measurement
contracts
Unit price
Cost Based
Contracts
Cost reimbursement
contracts
• Cost plus percentage fee
• Cost plus fixed fee
• Cost plus fluctuating fee
• Target cost
reimbursement
Guaranteed
Maximum Price
Procurement (CONS6817) Lara Tookey
PRICE BASED CONTRACTS
Procurement (CONS6817) Lara Tookey

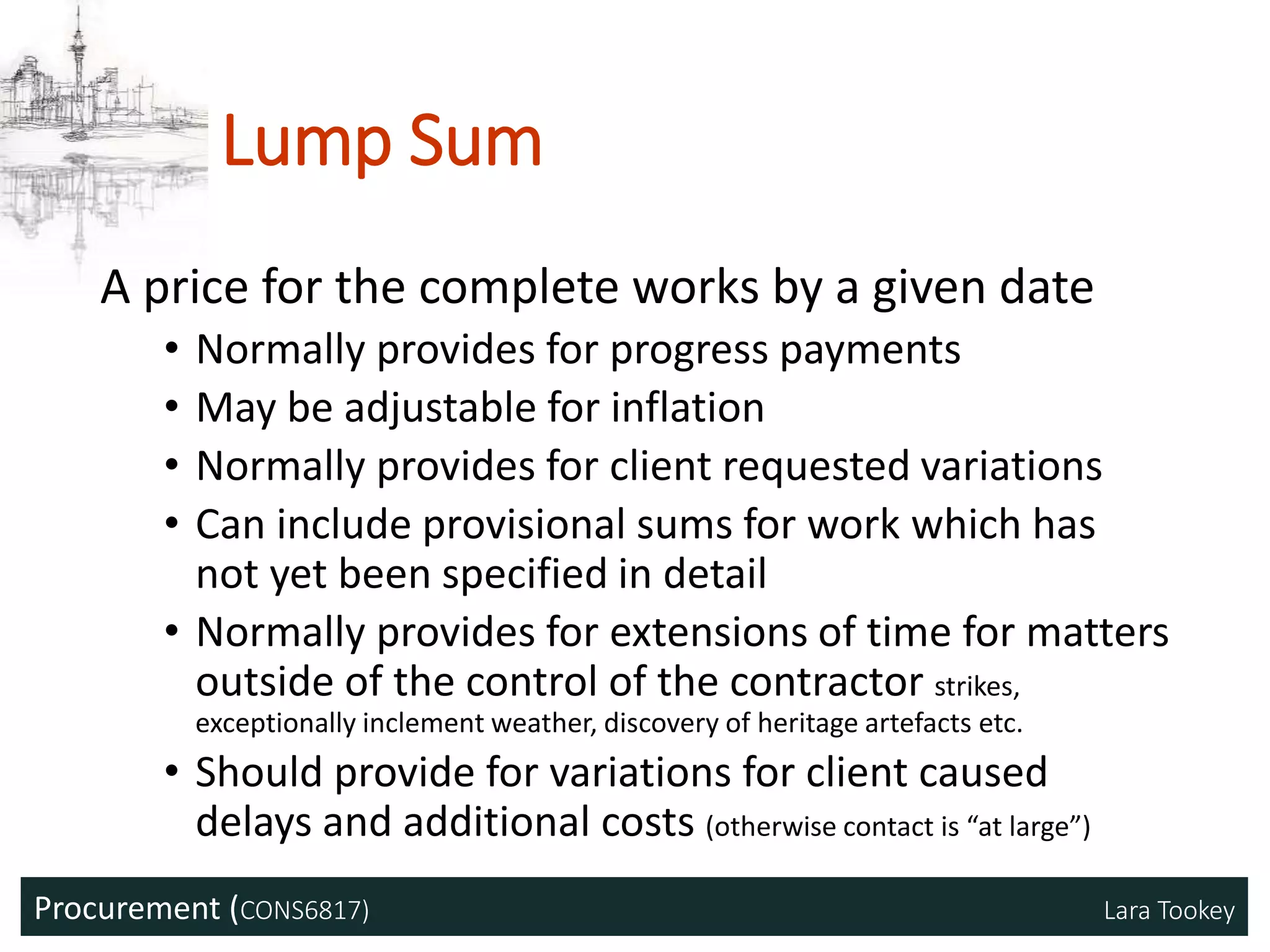

Lump Sum
A price for the complete works by a given date
• Normally provides for progress payments
• May be adjustable for inflation
• Normally provides for client requested variations
• Can include provisional sums for work which has
not yet been specified in detail
• Normally provides for extensions of time for matters
outside of the control of the contractor strikes,
exceptionally inclement weather, discovery of heritage artefacts etc.
• Should provide for variations for client caused
delays and additional costs (otherwise contact is “at large”)
Procurement (CONS6817) Lara Tookey
Lump Sum (cont’d)
• Can be used in any situation where the
extent of the work is known:
• Separated construction contracts, normally at
end of construction drawings phase
• Novated design & build at end of concept or
developed design phase
• Design & Build at end of concept drawing phase
(or later)
Contracts for Architectural or Engineering services
Procurement (CONS6817) Lara Tookey
A lump sum can be agreed:
1. through a tender process or
2. by negotiation
Procurement (CONS6817) Lara Tookey
Lump Sum
• They may also include incentives for meeting
or exceeding project objectives:
• Early opening
• Non- disruption of existing operations
• They may also include liquidated damages
provisions (not penalty clauses)
• Failure to complete on time
Procurement (CONS6817) Lara Tookey
Contracting risks
• Quantity takeoff
• Work missed and not included in estimate
• Subsurface conditions missed or improperly
evaluated
• Subcontractors only quoted partial scope of
work
Procurement (CONS6817) Lara Tookey
Unit Price
• Owner and Contractor agree on price to be
charged per unit for major elements.
• Owner or A/E provide estimated quantities for
project.
• No total final price.
• Overhead, profit, labour & material are all
included in unit price.
• Contractor is paid based on number of units
actually installed.
• Re-negotiate for rates if the quantity or work
considerably exceeds the initial target.
Procurement (CONS6817) Lara Tookey
Unit Price
• Prequalification important.
• Higher risk to owner.
• Ideal for work where quantities can not be
accurately established before construction
starts.
• Time and cost risk (shared)
• Owner: at risk for total quantities
• Contractor: at risk for fixed unit price.
Procurement (CONS6817) Lara Tookey
Measure and Value
• Prices for units of quantity of work are agreed
before the contract is signed (by bidding or
negotiation).
• Examples: $200 per m3 of concrete
$23 per m of 100 x 50mm timber framing
$135 each per door.
• As the work proceeds it is measured and the
contractor is paid according to the amount of
work done.
• Common in civil engineering projects (roads,
dams etc) .
• Unusual in building projects
Procurement (CONS6817) Lara Tookey
COST BASED CONTRACTS
Procurement (CONS6817) Lara Tookey
Cost-Plus Contracts
• Labour
• Materials
• Subcontractors
• On-site overheads
• Off-site overheads
• Profit
Payment based on actual costs
Can be on lump sum or cost plus
contracts
Lump sum or actual cost
Fixed fee or %
Distinguishing between these
can be an issue
Procurement (CONS6817) Lara Tookey
Cost-Plus Contracts
• Typically used where extent of work is not
known at the start
• Common in emergency situations
Procurement (CONS6817) Lara Tookey
Cost plus contracts with incentives
• Target cost: - painshare and gainshare
provisions whereby savings below and costs
above the target costs are shared between
client and contractor
• Guaranteed Maximum Price(GMP): - savings
below GMP are shared. Contractor pays all
costs above GMP (often used with design & build and
novated design and build contracts)
Procurement (CONS6817) Lara Tookey
Cost-Plus Contracts
• Aka “time and material” contract
• Owners agrees to pay contractor actual cost
to complete the Work PLUS and agreed-upon
fee
• Usually percentage of costs (10-15%)
• Owner beware…..
• What will be reimbursed and what is covered by
the fee.
• Used where scope of work is uncertain and
costs can easily become out of control.
• Often utilised in emergency situations.
Procurement (CONS6817) Lara Tookey
Cost-Plus
• Do not generally include GC HQ costs.
• Must be clear on what costs should be
considered when computing additional fees.
• Ie contract modifications; change orders could
consume the budget!
• Contract between GC and Subbie to specify
which costs are reimbursable.
• All field and project costs including labour,
materials, equipment, overheads, insurance,
bond premiums.
Procurement (CONS6817) Lara Tookey
Cost + Percentage of cost
(CPPC)
• Contractor is paid actual cost plus a % of the
total project costs.
• Fee = percentage of the total project cost
• Cost = $500 000;
• Fee = 2%
• Contract must clearly state what costs are
reimbursable.
Procurement (CONS6817) Lara Tookey
Cost + Fixed Fee (CPFF)
• Client agrees to reimburse contractor’s
actual costs, regardless of the amount, and
to pay negotiated fee that is unrelated to the
total cost of the project.
• Fee = percentage of the original estimated
total figure.
• Utilized on large multi-year projects.
• Estimated cost = $ 20 million
• Fee = 1% therefore fee equals $200,000
Procurement (CONS6817) Lara Tookey
Other variations
• Cost-Plus Fixed Fee with GMP
• Used when contractor is paid for the total
project cost plus a negotiated fee, but the total
does not exceed an agreed upon upper limit.
• Cost-Plus Fixed Fee with GMP and Bonus
• A bonus can be added to this compensation if
the project finishes below budget, ahead of
schedule etc.
• Cost-Plus Fixed Fee with agreement for
sharing any cost saving.
Procurement (CONS6817) Lara Tookey
Guaranteed Maximum Price
(GMP)
• An amount established in an agreement for a
project where the exact costs are not known
at the time of agreement.
• Same as Cost + Fee, but with a cap
• Contractor agrees not to exceed targeted costs
• Incentives are places in contract stating that
if costs come in below GMP, then Contractor
and Owner split savings.
• Contractor absorbs cost if above GMP.
Procurement (CONS6817) Lara Tookey
Cost + Fixed fee + profit
sharing clause
• Rewards contractors who minimise cost.
• Percentage of cost under GMP is considered
profit and shared with the contractor.
• Advantages:
• Provides incentives to the contractor to save money
• Disadvantages:
• Contractor must absorb any amount over the GMP.
• Detailed plans and specifications needed.
Procurement (CONS6817) Lara Tookey
Negotiated Contracts
• Priced as lump sum or cost-plus based on
complexity of the work items.
• Work items straightforward – lump sum
contract.
• Uncertainty associated with work – cost-plus
contract.

CONS6817_S04'16

  • 1.
    Procurement (CONS6817) LaraTookey PROCUREMENT – SESSION #4 Evaluation of Management variations. Contract Types
  • 2.
    Procurement (CONS6817) LaraTookeyOur focus for the course
  • 3.
    Procurement (CONS6817) LaraTookey Management Orientated Systems Morledge & Smith 2013 describe them as a separate classification but many consider them as more complex variants of Separated Systems
  • 4.
    Procurement (CONS6817) LaraTookey Service offered by Manager • Based on a fee • Coordination • Planning • Controlling • Managing design • Managing construction • Ensures contractor part of client team from outset • Maximum construction experience fed into design.
  • 5.
    Procurement (CONS6817) LaraTookey Used when….. • Project is large & complex • Fast-track procurement required • Client wishes to select designer separately • Often a result of a competition • Work is not sufficiently designed prior to construction • Design and technology designed in tandem
  • 6.
    Procurement (CONS6817) LaraTookey Used when….. • Project is organisationally complex • Flexibility is required throughout • Less adversarial approach is preferred • Choice of competitive tendering for each element is preferred • Target price rather than fixed lump sum accepted.
  • 7.
    Procurement (CONS6817) LaraTookey Using Management Orientated Systems to get better integration between design and construction
  • 8.
    Procurement (CONS6817) LaraTookey Integration of Design & Construction Objectives can include: • Need for contractor input into design phase: • Build efficiency • Incorporation of proprietary systems of contractor or subcontractor • Construction programming requirements effect design • Fast tracking requirements • Coordination of the design outputs with overlapping construction programme
  • 9.
    Procurement (CONS6817) LaraTookey Management Orientated Procurement Options Construction Management Management Contracting Design & Manage
  • 10.
    Procurement (CONS6817) LaraTookey Management contracting • A management contractor undertakes to perform the works through trade contractors who are contractually accountable to the management contractor. • Does not undertake the work themselves • Strictly MANAGEMENT • However, the management contractor is not strictly liable for the consequences of any default by trade contractors – as long as the management contractor has complied with its management obligation (generally a skill and care obligation) under the management contract.
  • 11.
    Procurement (CONS6817) LaraTookey The Process • C employs A/E to produce outline design • MC companies can bid for work • Best “overall submission” should win • Fee, management, programme, track record etc. • Winning contractor joins team • Advises designers in completion of design, organises construction in parallel by employing “works package contractors” • Contractor appointed at early stage and works for a fee • Fee can be a % • Can incorporate a GMP • Fee can be a bid • Client pays COST of packages + fee on monthly basis
  • 12.
    Procurement (CONS6817) LaraTookey • Probity issues can be covered • Sub-contractors normally appointed by an ‘open book’ bid process
  • 13.
    Procurement (CONS6817) LaraTookey Construction management • Owners engage construction managers (CMs) to assist in developing bid documents and overseeing project construction. • CM: • Is a professional or a firm trained in the management of construction processes. • Is generally interposed between the owner and some or all of the other participants.
  • 14.
    Procurement (CONS6817) LaraTookey There are two general types of CM: • Agency Construction Managers (ACM) • Aka Construction Manager as Adviser (CMa) • Construction managers-at-risk (CMr) • Aka Construction Manager as Constructor (CMc)
  • 15.
    Procurement (CONS6817) LaraTookey Construction Manager as Adviser • CMa acts as an agent of the owner and extends the owner’s internal capabilities in performing traditional owner responsibilities. • The level of service by the CMa can range from on- call advice to full project management.
  • 16.
    Procurement (CONS6817) LaraTookey Construction Manager as Adviser • In some cases, the owner hires the CMa before design begins and CMa may participate in the selection of and contracting with the designer or might even be the designer.
  • 17.
    Procurement (CONS6817) LaraTookey Construction Manager as Adviser • O retains A and CM who acts as an independent adviser to the owner. • Prime contractor(s) responsible for construction, labour and materials. • CM gives O construction management advice through design and construction phase. • Increases expertise in managing a project from start to finish.
  • 18.
    Procurement (CONS6817) LaraTookey Construction Manager as Adviser (CMa) Contract Relationship Owner Consultant Architect Const. Manager Adviser (CMa) Consultant Contractor Contractor Sub- contractor Sub- contractor Multiple prime contractors
  • 19.
    Procurement (CONS6817) LaraTookey What is Multi-prime CM? • Several specialty contractors are engaged to do specific portions of the work • Each contractor has a direct contract with the owner • Breakdown of work may be by phase, by trade, or both • Each prime contractor may also have subcontractors • Work is managed for the owner by a CMa firm
  • 20.
    Procurement (CONS6817) LaraTookey Construction Manager as Constructor (CMc)/(CMr) • Single party (Construction Manager) provides construction management services in pre- construction phase AND then completes construction. • Gives CM Constructor responsibility and control over construction work via direct contracts with sub-contractors.
  • 21.
    Procurement (CONS6817) LaraTookey Construction Manager as Constructor (CMc) aka Owner Consultant Architect Const. Manager Constructor (CMc) Consultant Sub- contractor Sub- contractor Construction Manager at Risk (CMr)
  • 22.
    Procurement (CONS6817) LaraTookey CM(r) typically contracts with the owner in two stages. • First, CMr manages and undertakes services during conceptual & preliminary design phases with the design professional. • When design is complete, owner and CMr then agree on a price and schedule for the completion of the construction work.
  • 23.
    Procurement (CONS6817) LaraTookey Design & Manage Similar to the previous, except the design consultant manages the work package contractors.
  • 24.
    Procurement (CONS6817) LaraTookey CONTRACT TYPES 3910 - Conditions of contract for building and civil engineering 3916 - Conditions of contract for building and civil engineering – Design & Construct 3917 – Conditions of contract for building and civil engineering – Fixed Term
  • 25.
    Procurement (CONS6817) LaraTookey The Chosen procurement arrangement dominates…. • How the project is performed • Contractual duties of the parties concerned • Terms and conditions of the contracts to be executed
  • 26.
    Procurement (CONS6817) LaraTookey Construction contracts • A construction contract is a mutually legally binding agreement that gives rights and places obligations on both parties • obligates the seller to provide specified products or services, • and obligates the buyer to pay for them.
  • 27.
    Procurement (CONS6817) LaraTookey Client • Rights: • To receive the work specified at the time and for the price specified. • Obligations: • To hand over the site • To provide required information • Not to impede the progress of the work • To pay as agreed
  • 28.
    Procurement (CONS6817) LaraTookey Contractor • Rights • To be given possession of the site • To control their operations as they see fit • To receive necessary information in good time • To be paid as agreed • Obligations • To carry out the work as specified • To take instructions from the client’s representative • To deliver at the agreed time
  • 29.
    Procurement (CONS6817) LaraTookey PRICE MECHANISMS IN CONTRACTS
  • 30.
    Procurement (CONS6817) LaraTookey Price Based Contracts Lump sum contracts (Re-) Measurement contracts Unit price Cost Based Contracts Cost reimbursement contracts • Cost plus percentage fee • Cost plus fixed fee • Cost plus fluctuating fee • Target cost reimbursement Guaranteed Maximum Price
  • 31.
    Procurement (CONS6817) LaraTookey PRICE BASED CONTRACTS
  • 32.
    Procurement (CONS6817) LaraTookey Lump Sum A price for the complete works by a given date • Normally provides for progress payments • May be adjustable for inflation • Normally provides for client requested variations • Can include provisional sums for work which has not yet been specified in detail • Normally provides for extensions of time for matters outside of the control of the contractor strikes, exceptionally inclement weather, discovery of heritage artefacts etc. • Should provide for variations for client caused delays and additional costs (otherwise contact is “at large”)
  • 33.
    Procurement (CONS6817) LaraTookey Lump Sum (cont’d) • Can be used in any situation where the extent of the work is known: • Separated construction contracts, normally at end of construction drawings phase • Novated design & build at end of concept or developed design phase • Design & Build at end of concept drawing phase (or later) Contracts for Architectural or Engineering services
  • 34.
    Procurement (CONS6817) LaraTookey A lump sum can be agreed: 1. through a tender process or 2. by negotiation
  • 35.
    Procurement (CONS6817) LaraTookey Lump Sum • They may also include incentives for meeting or exceeding project objectives: • Early opening • Non- disruption of existing operations • They may also include liquidated damages provisions (not penalty clauses) • Failure to complete on time
  • 36.
    Procurement (CONS6817) LaraTookey Contracting risks • Quantity takeoff • Work missed and not included in estimate • Subsurface conditions missed or improperly evaluated • Subcontractors only quoted partial scope of work
  • 37.
    Procurement (CONS6817) LaraTookey Unit Price • Owner and Contractor agree on price to be charged per unit for major elements. • Owner or A/E provide estimated quantities for project. • No total final price. • Overhead, profit, labour & material are all included in unit price. • Contractor is paid based on number of units actually installed. • Re-negotiate for rates if the quantity or work considerably exceeds the initial target.
  • 38.
    Procurement (CONS6817) LaraTookey Unit Price • Prequalification important. • Higher risk to owner. • Ideal for work where quantities can not be accurately established before construction starts. • Time and cost risk (shared) • Owner: at risk for total quantities • Contractor: at risk for fixed unit price.
  • 39.
    Procurement (CONS6817) LaraTookey Measure and Value • Prices for units of quantity of work are agreed before the contract is signed (by bidding or negotiation). • Examples: $200 per m3 of concrete $23 per m of 100 x 50mm timber framing $135 each per door. • As the work proceeds it is measured and the contractor is paid according to the amount of work done. • Common in civil engineering projects (roads, dams etc) . • Unusual in building projects
  • 40.
    Procurement (CONS6817) LaraTookey COST BASED CONTRACTS
  • 41.
    Procurement (CONS6817) LaraTookey Cost-Plus Contracts • Labour • Materials • Subcontractors • On-site overheads • Off-site overheads • Profit Payment based on actual costs Can be on lump sum or cost plus contracts Lump sum or actual cost Fixed fee or % Distinguishing between these can be an issue
  • 42.
    Procurement (CONS6817) LaraTookey Cost-Plus Contracts • Typically used where extent of work is not known at the start • Common in emergency situations
  • 43.
    Procurement (CONS6817) LaraTookey Cost plus contracts with incentives • Target cost: - painshare and gainshare provisions whereby savings below and costs above the target costs are shared between client and contractor • Guaranteed Maximum Price(GMP): - savings below GMP are shared. Contractor pays all costs above GMP (often used with design & build and novated design and build contracts)
  • 44.
    Procurement (CONS6817) LaraTookey Cost-Plus Contracts • Aka “time and material” contract • Owners agrees to pay contractor actual cost to complete the Work PLUS and agreed-upon fee • Usually percentage of costs (10-15%) • Owner beware….. • What will be reimbursed and what is covered by the fee. • Used where scope of work is uncertain and costs can easily become out of control. • Often utilised in emergency situations.
  • 45.
    Procurement (CONS6817) LaraTookey Cost-Plus • Do not generally include GC HQ costs. • Must be clear on what costs should be considered when computing additional fees. • Ie contract modifications; change orders could consume the budget! • Contract between GC and Subbie to specify which costs are reimbursable. • All field and project costs including labour, materials, equipment, overheads, insurance, bond premiums.
  • 46.
    Procurement (CONS6817) LaraTookey Cost + Percentage of cost (CPPC) • Contractor is paid actual cost plus a % of the total project costs. • Fee = percentage of the total project cost • Cost = $500 000; • Fee = 2% • Contract must clearly state what costs are reimbursable.
  • 47.
    Procurement (CONS6817) LaraTookey Cost + Fixed Fee (CPFF) • Client agrees to reimburse contractor’s actual costs, regardless of the amount, and to pay negotiated fee that is unrelated to the total cost of the project. • Fee = percentage of the original estimated total figure. • Utilized on large multi-year projects. • Estimated cost = $ 20 million • Fee = 1% therefore fee equals $200,000
  • 48.
    Procurement (CONS6817) LaraTookey Other variations • Cost-Plus Fixed Fee with GMP • Used when contractor is paid for the total project cost plus a negotiated fee, but the total does not exceed an agreed upon upper limit. • Cost-Plus Fixed Fee with GMP and Bonus • A bonus can be added to this compensation if the project finishes below budget, ahead of schedule etc. • Cost-Plus Fixed Fee with agreement for sharing any cost saving.
  • 49.
    Procurement (CONS6817) LaraTookey Guaranteed Maximum Price (GMP) • An amount established in an agreement for a project where the exact costs are not known at the time of agreement. • Same as Cost + Fee, but with a cap • Contractor agrees not to exceed targeted costs • Incentives are places in contract stating that if costs come in below GMP, then Contractor and Owner split savings. • Contractor absorbs cost if above GMP.
  • 50.
    Procurement (CONS6817) LaraTookey Cost + Fixed fee + profit sharing clause • Rewards contractors who minimise cost. • Percentage of cost under GMP is considered profit and shared with the contractor. • Advantages: • Provides incentives to the contractor to save money • Disadvantages: • Contractor must absorb any amount over the GMP. • Detailed plans and specifications needed.
  • 51.
    Procurement (CONS6817) LaraTookey Negotiated Contracts • Priced as lump sum or cost-plus based on complexity of the work items. • Work items straightforward – lump sum contract. • Uncertainty associated with work – cost-plus contract.

Editor's Notes

  • #38 Ad – Provides owner with a competitive bid situation that allows for fair price to complete work; eliminates changes Dis – Owner is placing huge faith in the A/E for correct estimated quantities.
  • #39 Ad – Provides owner with a competitive bid situation that allows for fair price to complete work; eliminates changes Dis – Owner is placing huge faith in the A/E for correct estimated quantities.
  • #50 Ad – Gives owner assurance that construction costs will not skyrocket Dis – Contractor must keep careful watch on costs and Owner may have to sacrifice quality over money.
