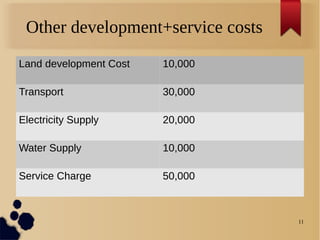

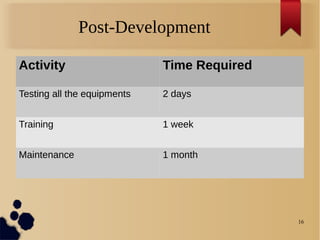

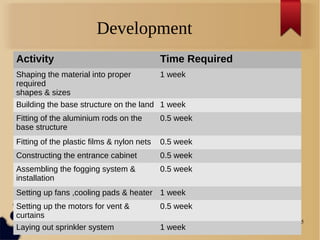

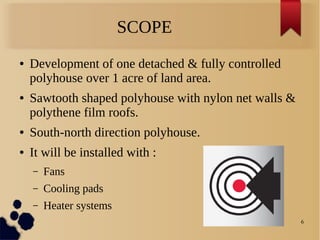

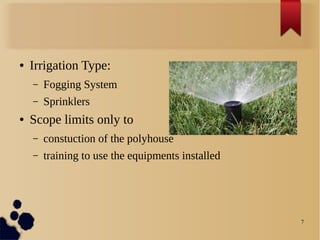

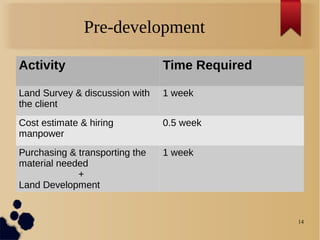

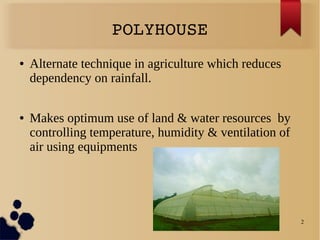

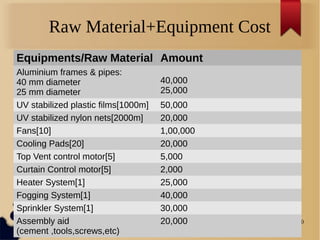

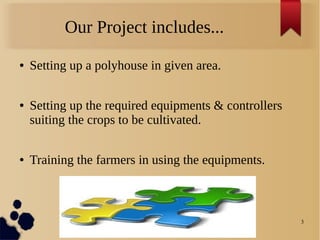

The document outlines a polyhouse development project aimed at optimizing agricultural practices by reducing reliance on rainfall and utilizing advanced equipment for climate control. It details the project's scope, estimated costs totaling approximately Rs. 5,57,000, and a timeline estimating 82 days for development and maintenance. Key components include construction specifications, equipment listings, and training for farmers on the newly installed systems.
