BUSINESS REQUIREMENTS
By: Mena Mostafa Apr-2015
Gathering & Analysis Workshop
A key to project success
WHO AM I?
Mena Mostafa
 Instructor, Coach & Advisor
 15 years experience (software development field)
 Project Manager, Business Analyst & Developer
 Worked in the enterprises world (ASSET, ITWorx,
etisalat…)
 Managed over 150 projects (simple websites, portals,
ERP, eCommerce, games…)
 Requirements gathering & management SME in ITWorx
 Led teams (co-located, remote, vendors)
 Joined the entrepreneurship & the world of startups

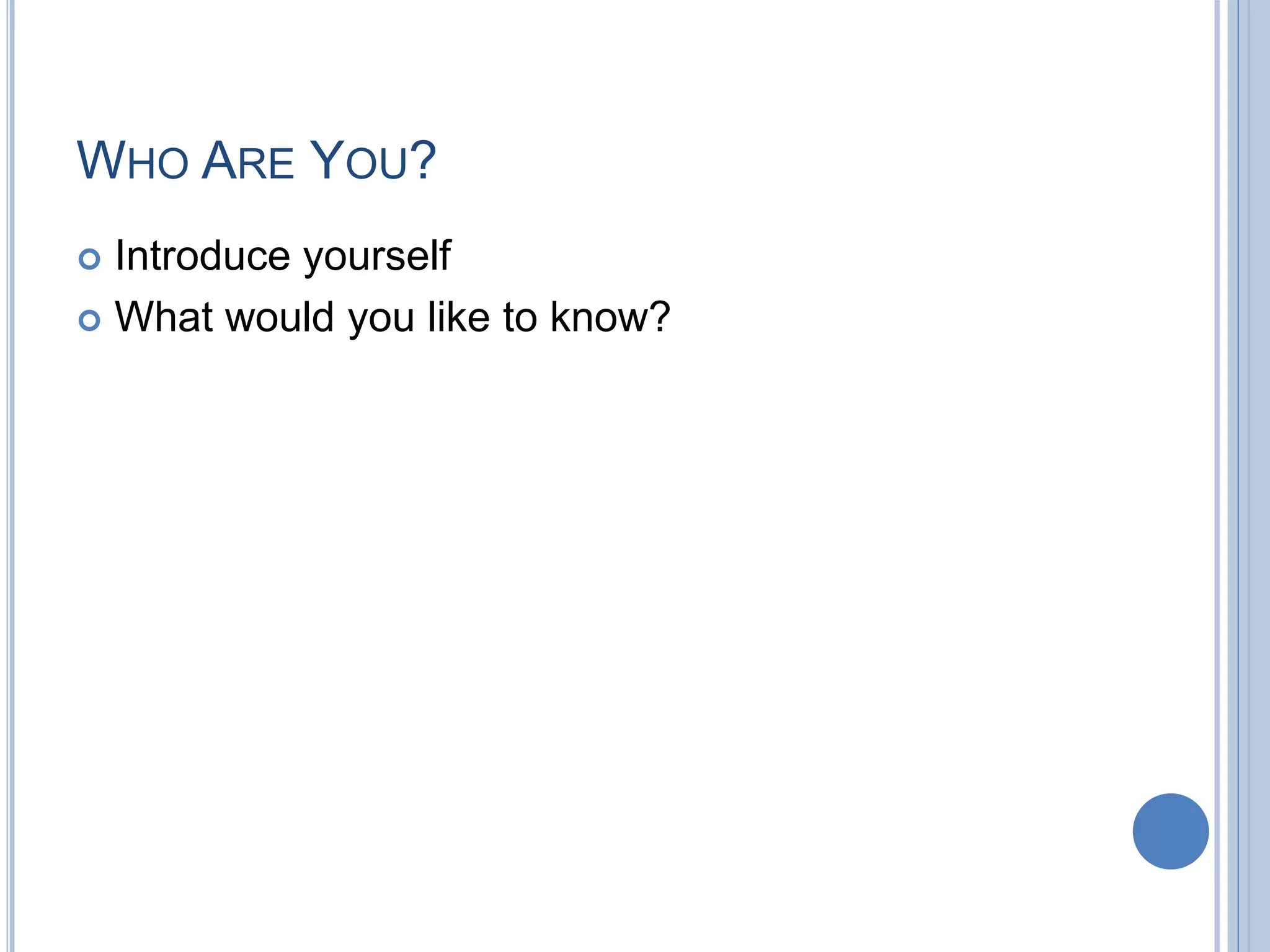

WHO ARE YOU?
 Introduce yourself
 What would you like to know?

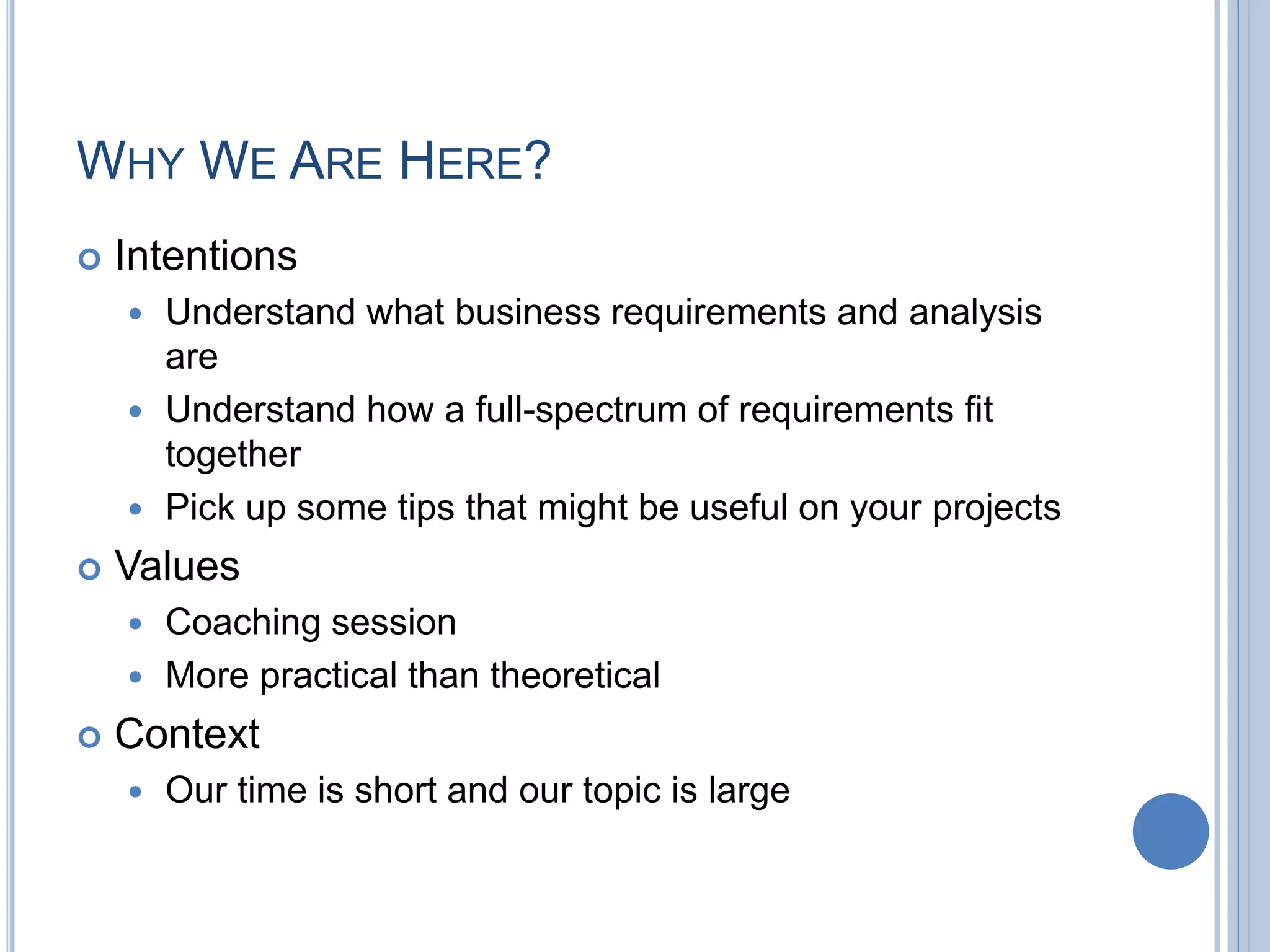

WHY WE ARE HERE?
 Intentions
 Understand what business requirements and analysis
are
 Understand how a full-spectrum of requirements fit
together
 Pick up some tips that might be useful on your projects
 Values
 Coaching session
 More practical than theoretical
 Context
 Our time is short and our topic is large

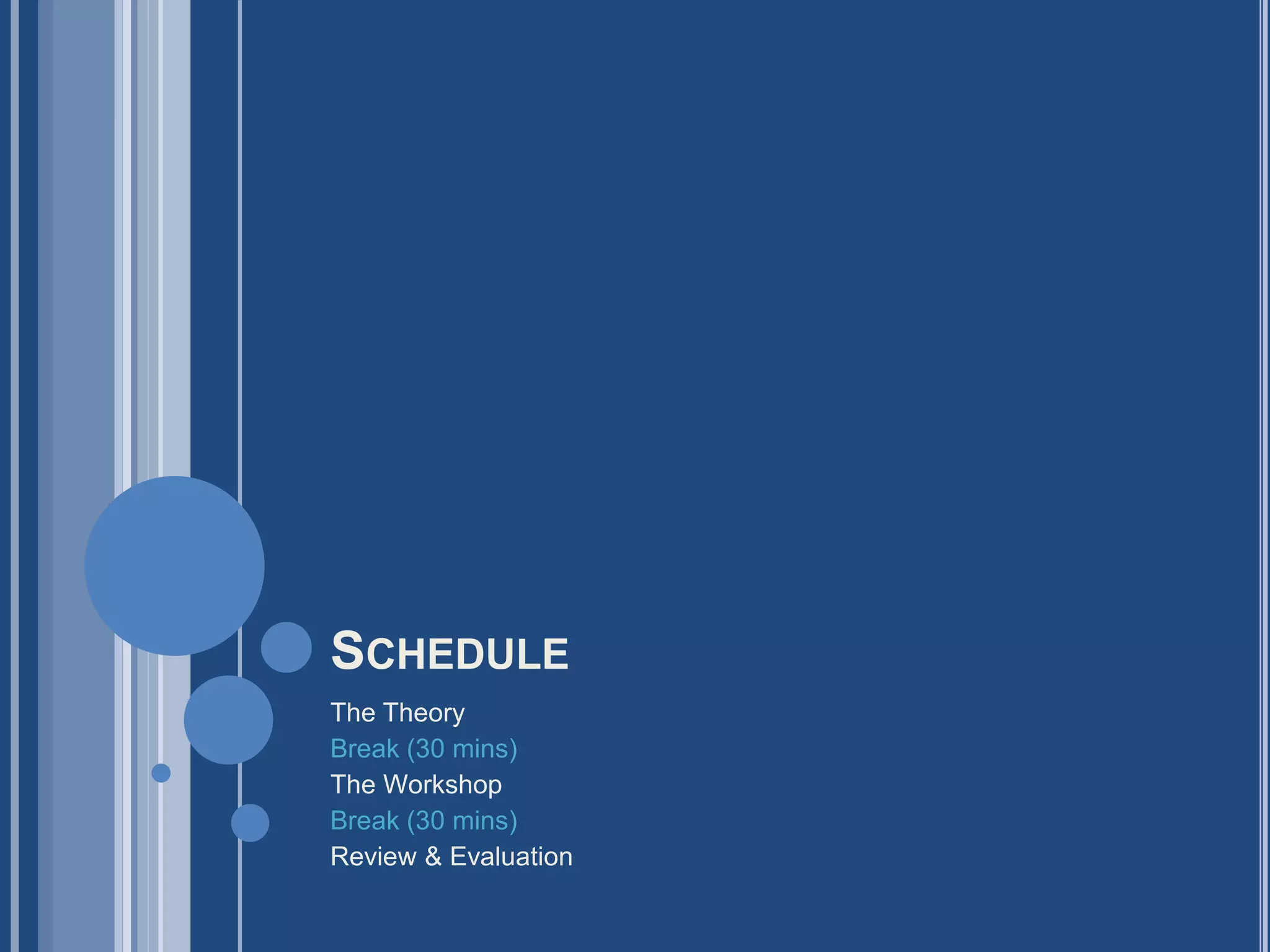

SCHEDULE
The Theory
Break (30 mins)
The Workshop
Break (30 mins)

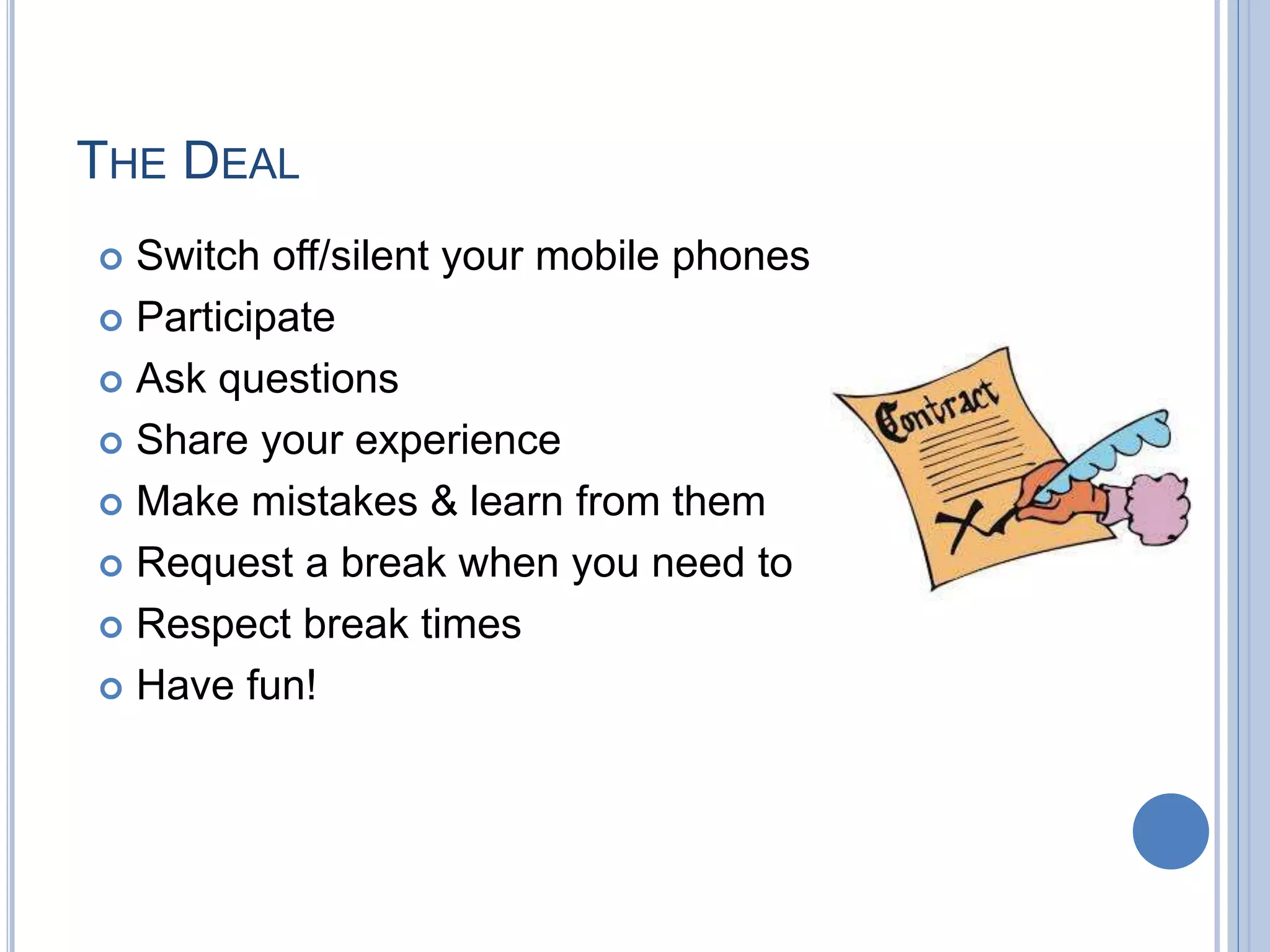

Review & Evaluation
 Switch off/silent your mobile phones
 Participate
 Ask questions
 Share your experience
 Make mistakes & learn from them
 Request a break when you need to
 Respect break times
 Have fun!
THE DEAL

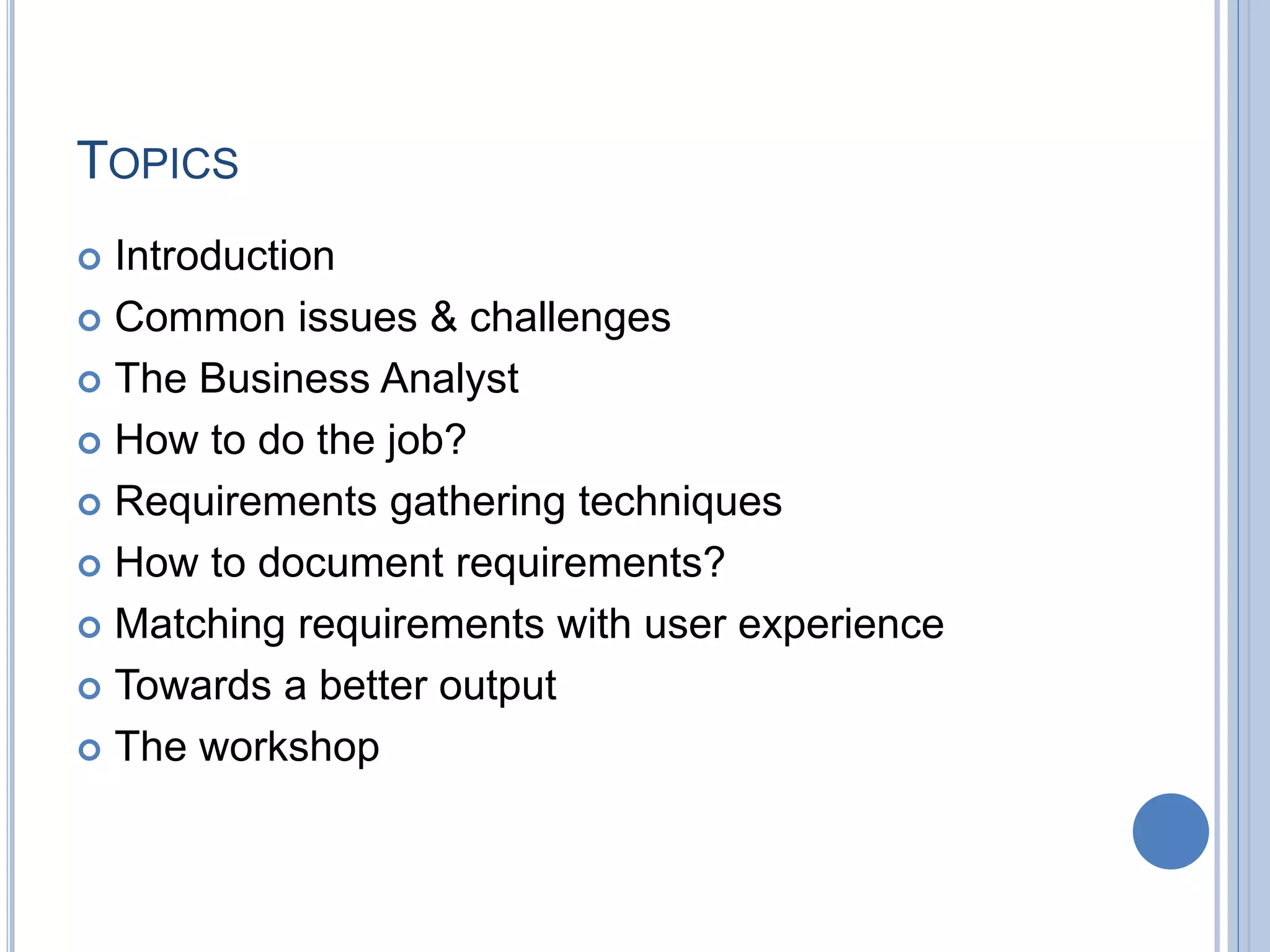

TOPICS
 Introduction
 Common issues & challenges
 The Business Analyst
 How to do the job?

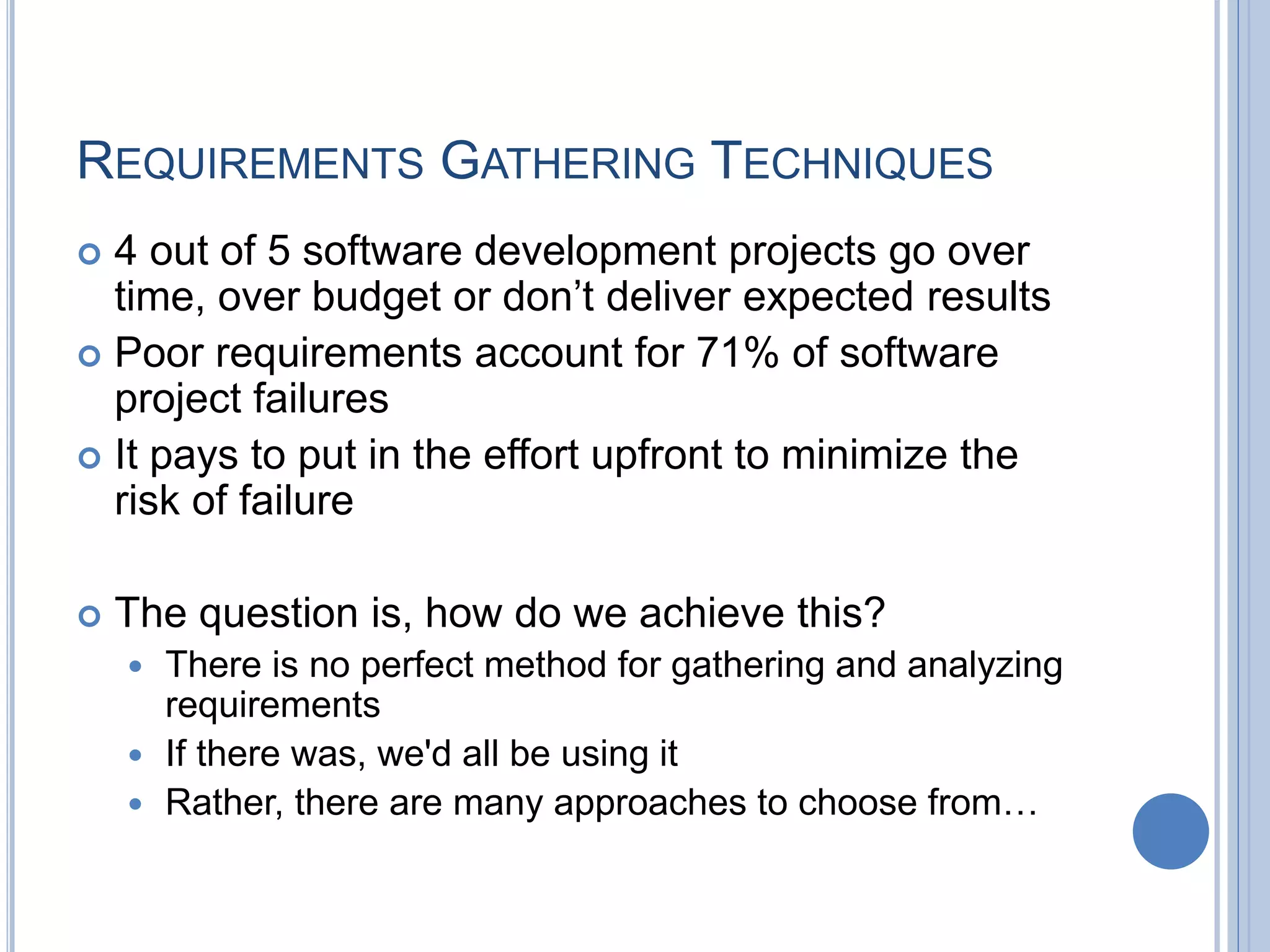

 Requirements gathering techniques
 How to document requirements?
 Matching requirements with user experience
 Towards a better output
 The workshop
INTRODUCTION
Why Requirements Gathering & Analysis?
What Is Requirements Gathering?
Types of Software Projects
Requirements & Features
Types of Requirements

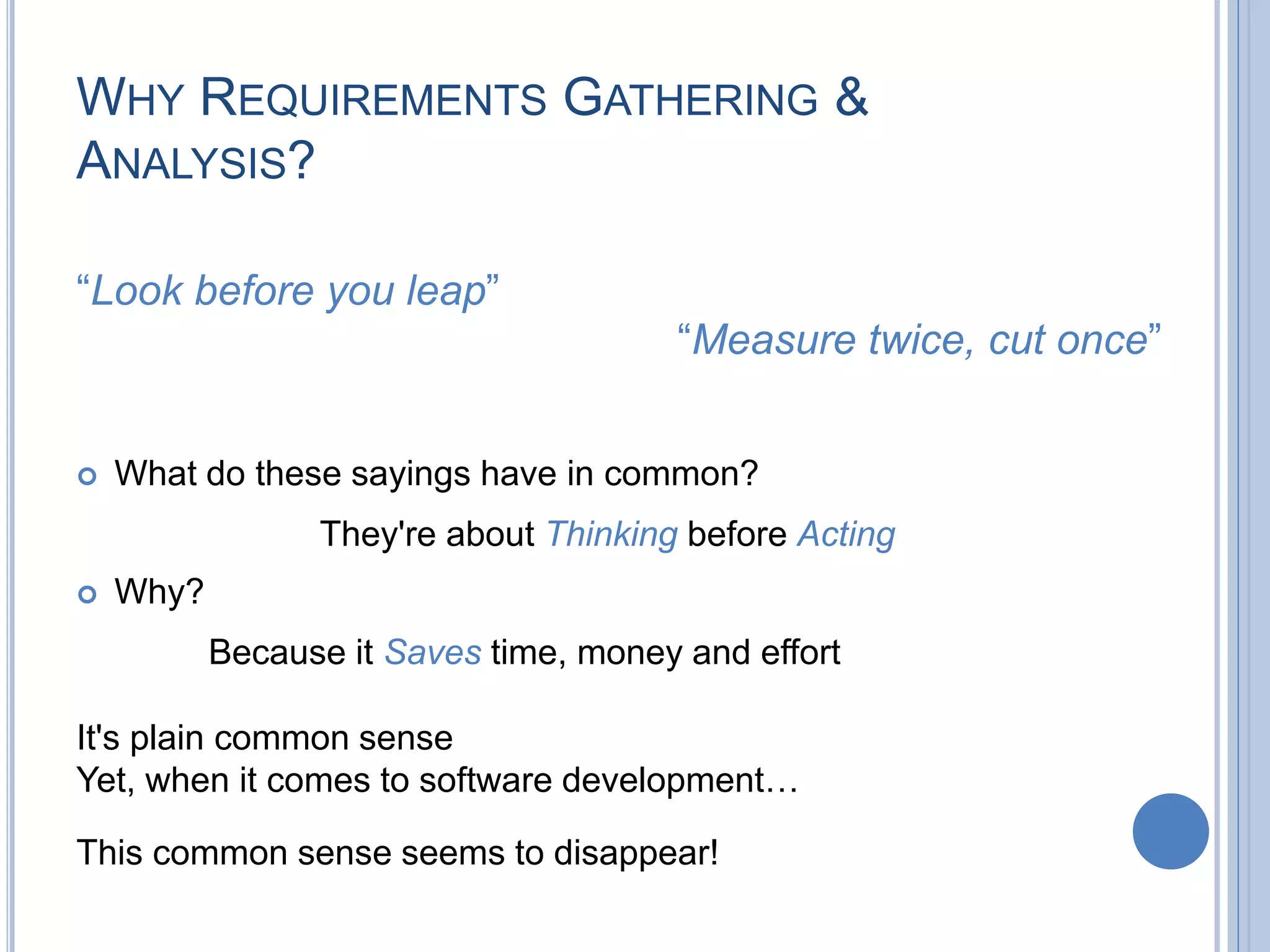

WHY REQUIREMENTS GATHERING &
ANALYSIS?
This common sense seems to disappear!
“Measure twice, cut once”
“Look before you leap”
 What do these sayings have in common?
They're about Thinking before Acting
 Why?
Because it Saves time, money and effort
It's plain common sense
Yet, when it comes to software development…

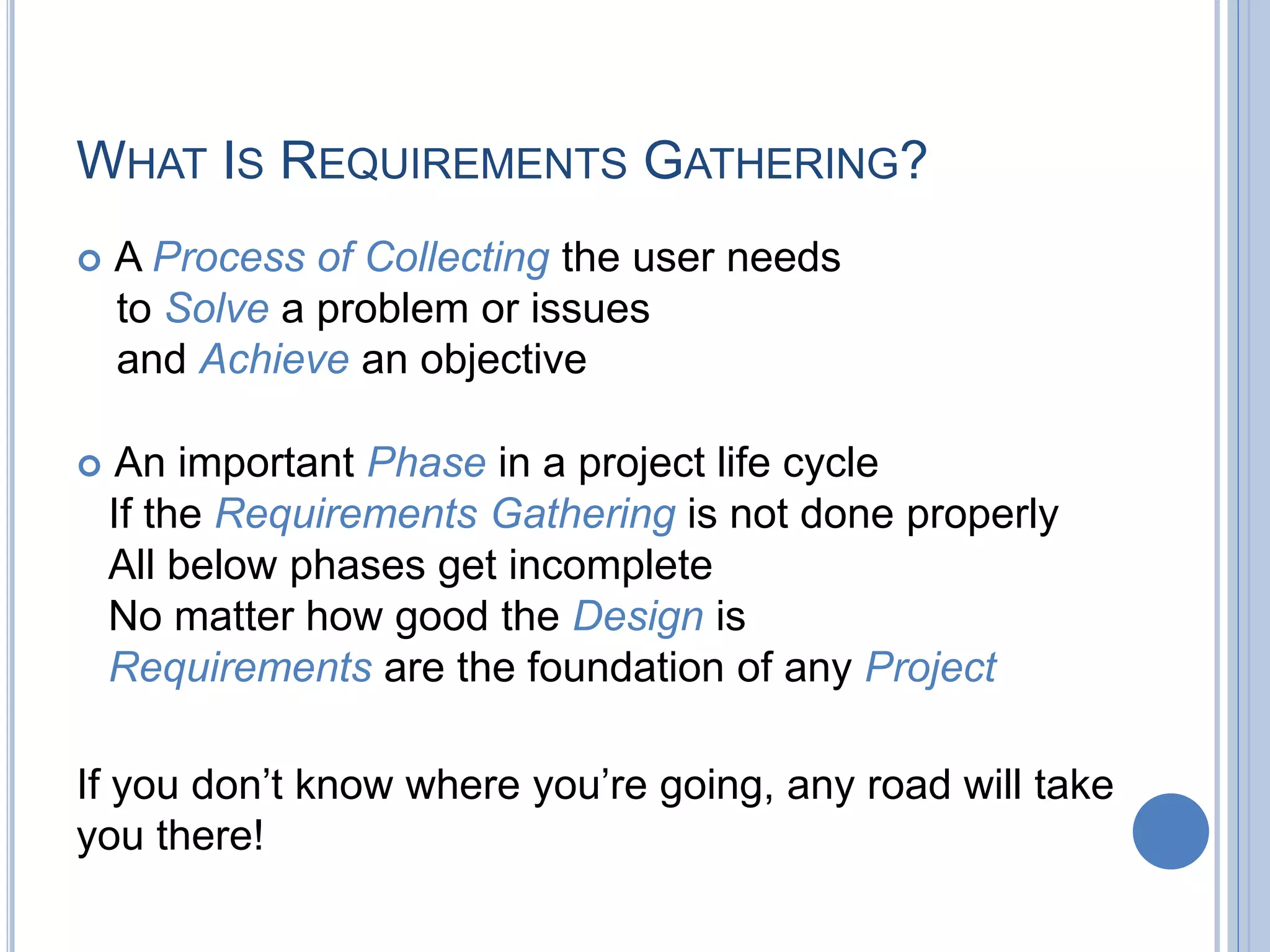

WHAT IS REQUIREMENTS GATHERING?
 A Process of Collecting the user needs
to Solve a problem or issues
and Achieve an objective
 An important Phase in a project life cycle
If the Requirements Gathering is not done properly
All below phases get incomplete
No matter how good the Design is
Requirements are the foundation of any Project
If you don’t know where you’re going, any road will take
you there!
TYPES OF SOFTWARE PROJECTS
 New Development: services & products
 Implementation: customization on existing software
(service or product)
 Research: proof of concept for new ideas
 Bug Fixing & Modifications: on existing software
(service or product)
 Maintenance & Support: on existing software
(service or product)

WHAT IS A REQUIREMENT?
 A requirement is a capability that a product must
possess to satisfy a customer need or objective
 A key component of any business project
 They help a project team define
 Goals
 Scope of the work
 They provide objective ways to measure the
project's success

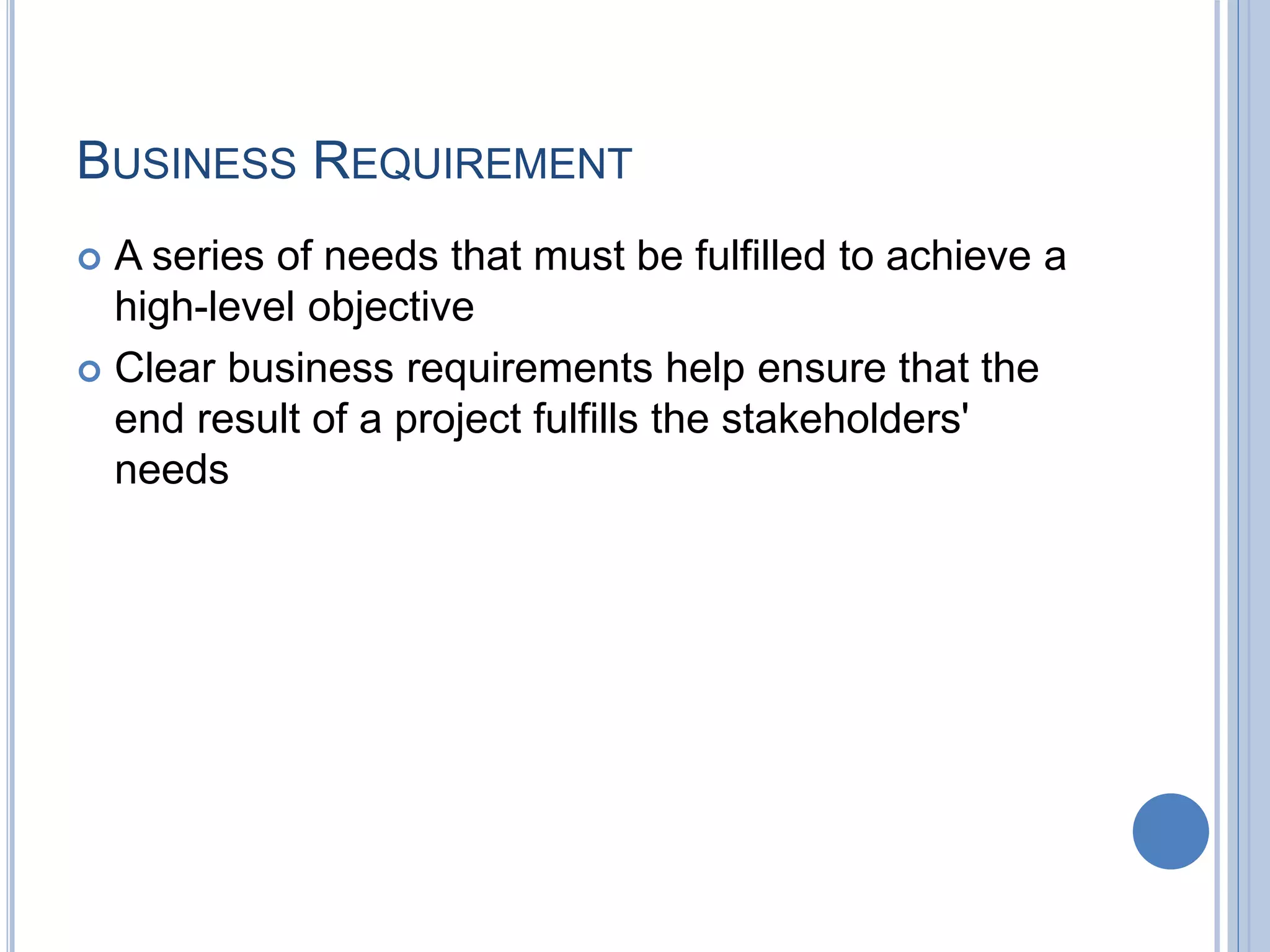

BUSINESS REQUIREMENT
 A series of needs that must be fulfilled to achieve a
high-level objective
 Clear business requirements help ensure that the
end result of a project fulfills the stakeholders'
needs

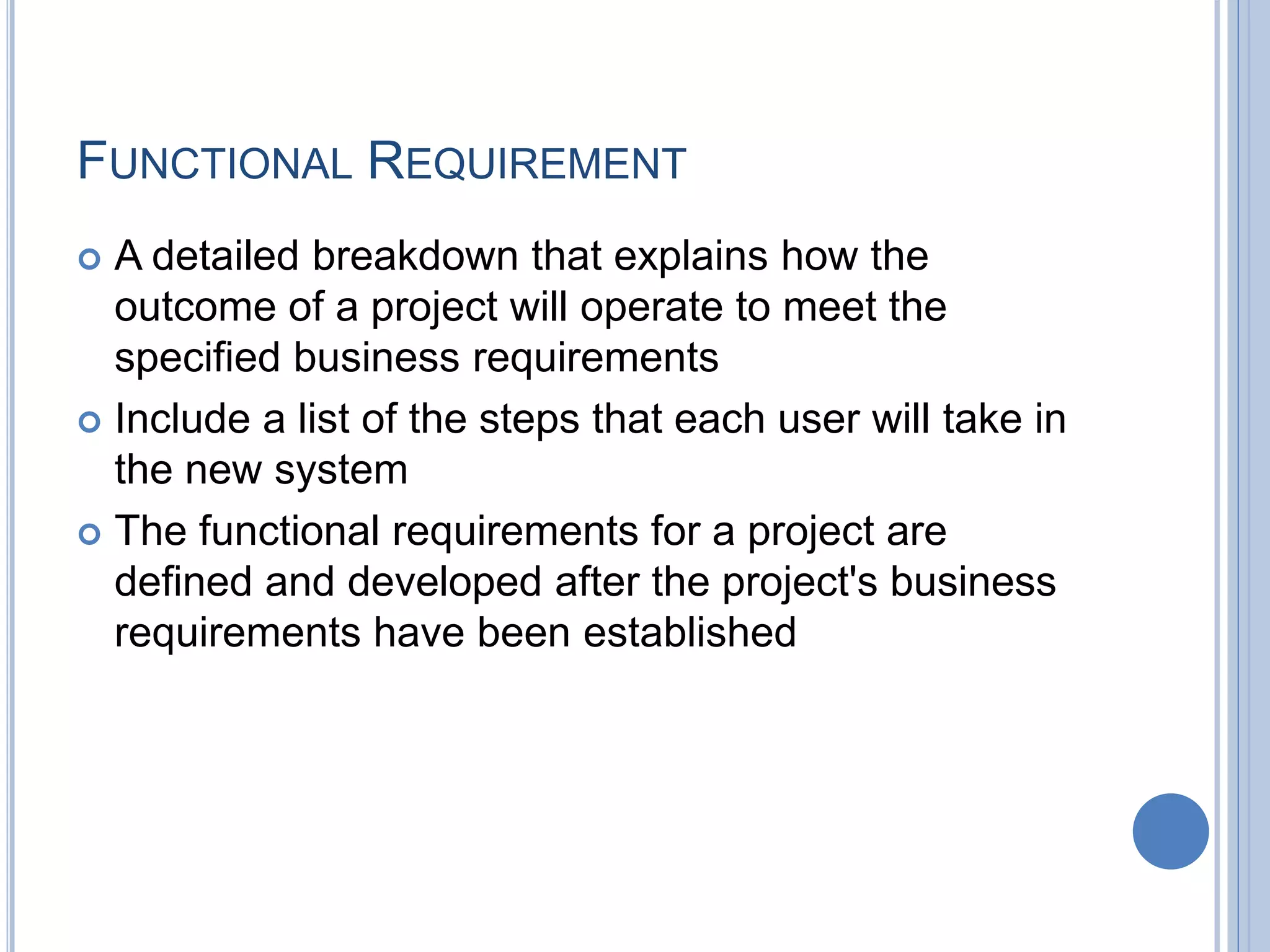

FUNCTIONAL REQUIREMENT
 A detailed breakdown that explains how the
outcome of a project will operate to meet the
specified business requirements
 Include a list of the steps that each user will take in
the new system
 The functional requirements for a project are
defined and developed after the project's business
requirements have been established

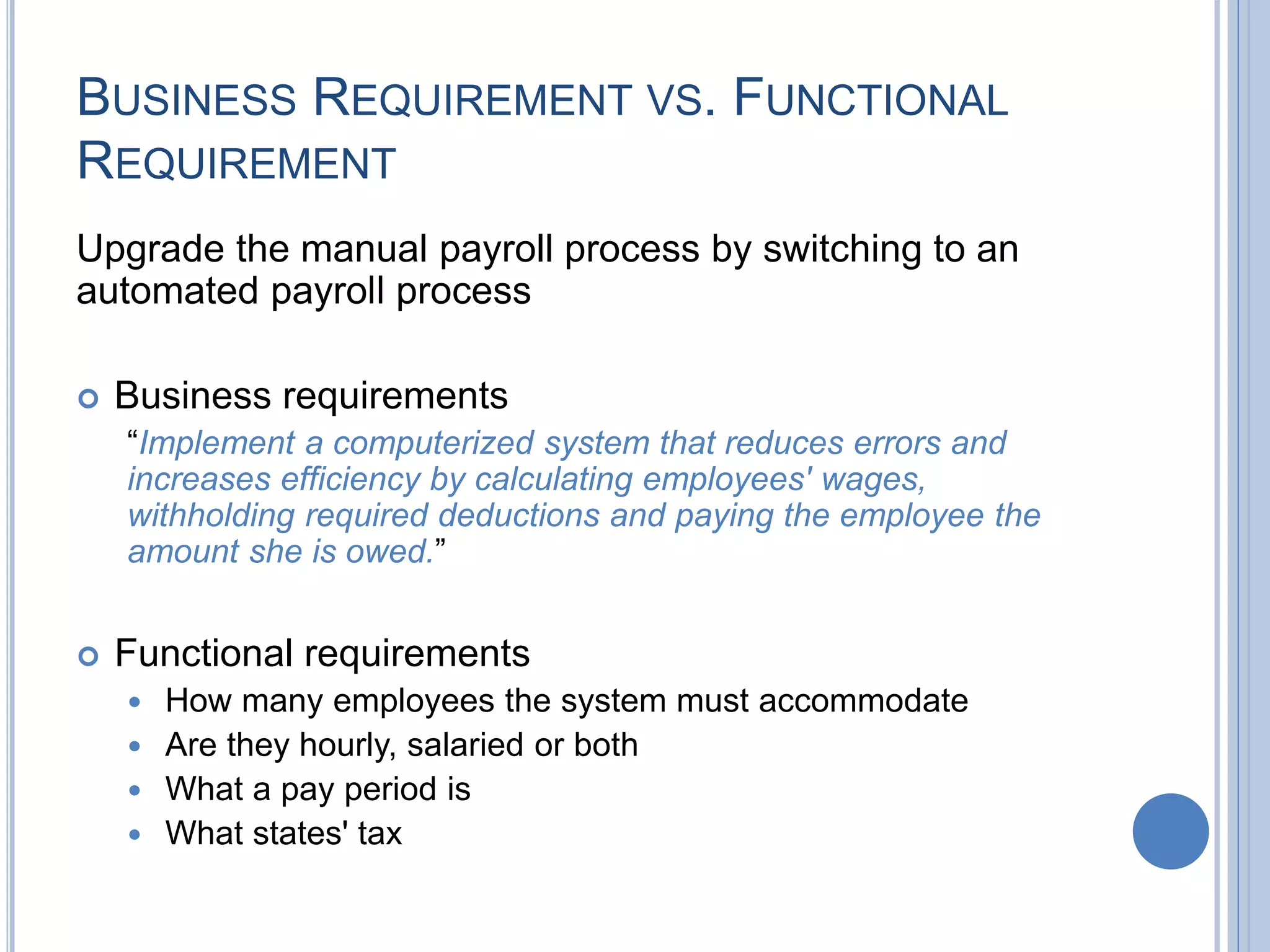

BUSINESS REQUIREMENT VS. FUNCTIONAL
REQUIREMENT
Upgrade the manual payroll process by switching to an
automated payroll process
 Business requirements
“Implement a computerized system that reduces errors and
increases efficiency by calculating employees' wages,
withholding required deductions and paying the employee the
amount she is owed.”
 Functional requirements
 How many employees the system must accommodate
 Are they hourly, salaried or both
 What a pay period is
 What states' tax

NON-FUNCTIONAL REQUIREMENTS
 What an organization needs to do to support the
project's outcome during and after implementation
 Examples:
 Hardware
 Software
 Performance
 Number of normal and concurrent users
 Page response time
 Usability
 Cultural aspects
 Availability
 Reliability
 Maintainability
 Extensibility
 Security…

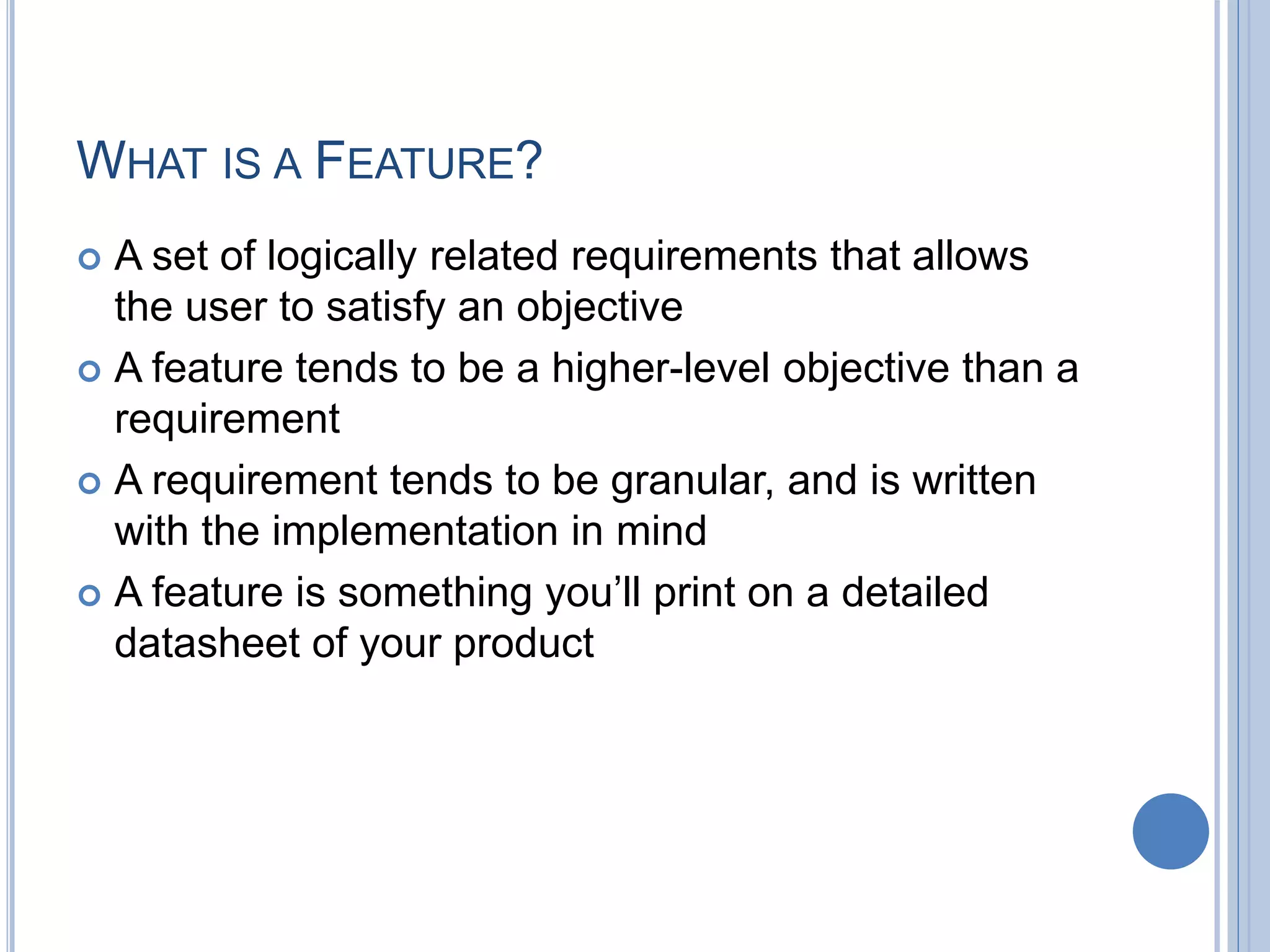

WHAT IS A FEATURE?
 A set of logically related requirements that allows
the user to satisfy an objective
 A feature tends to be a higher-level objective than a
requirement
 A requirement tends to be granular, and is written
with the implementation in mind
 A feature is something you’ll print on a detailed
datasheet of your product

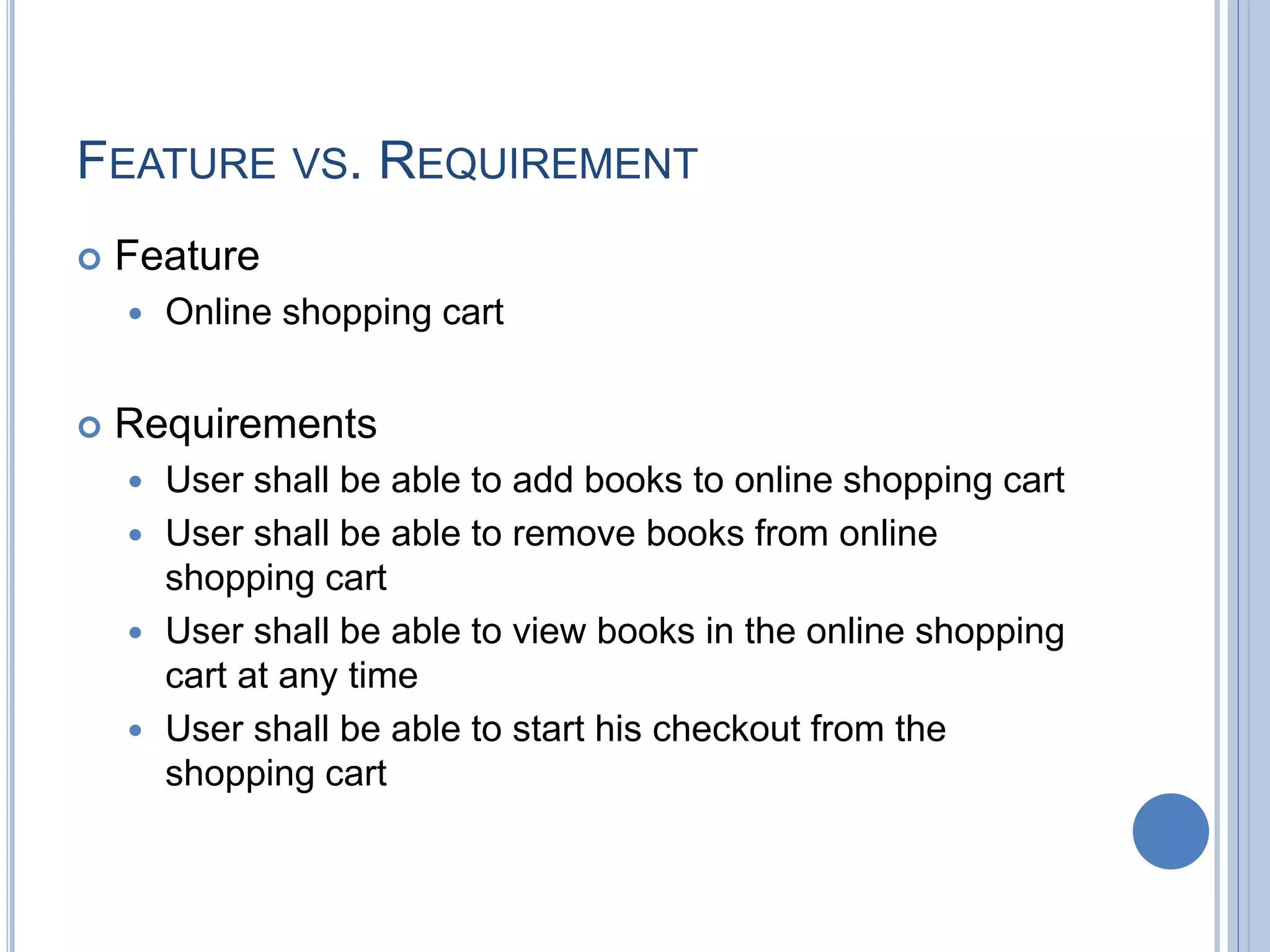

FEATURE VS. REQUIREMENT
 Feature
 Online shopping cart
 Requirements
 User shall be able to add books to online shopping cart
 User shall be able to remove books from online
shopping cart
 User shall be able to view books in the online shopping
cart at any time
 User shall be able to start his checkout from the
shopping cart
I’m trying to write a DOS bat file that runs an Access
macro to import a CSV output file from my COBOL
program. Any help would be appreciated!

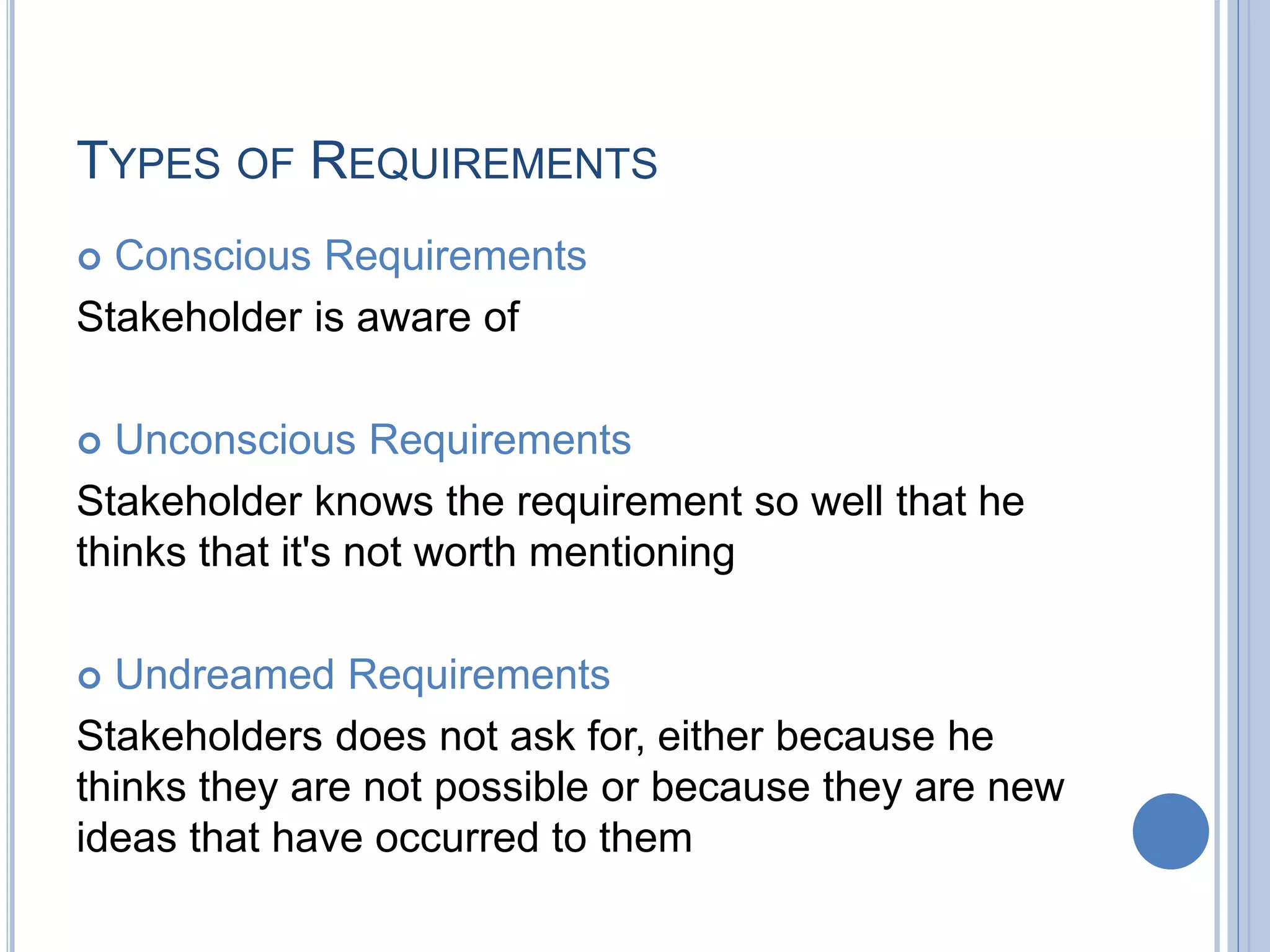

TYPES OF REQUIREMENTS
 Conscious Requirements
Stakeholder is aware of
 Unconscious Requirements
Stakeholder knows the requirement so well that he
thinks that it's not worth mentioning
 Undreamed Requirements
Stakeholders does not ask for, either because he
thinks they are not possible or because they are new
ideas that have occurred to them
COMMON ISSUES & CHALLENGES
Why Do Projects Fail?
Requirements Gathering Challenges
Requirements Volatility Causes
What Causes Changes to Requirements?
Scope Creep

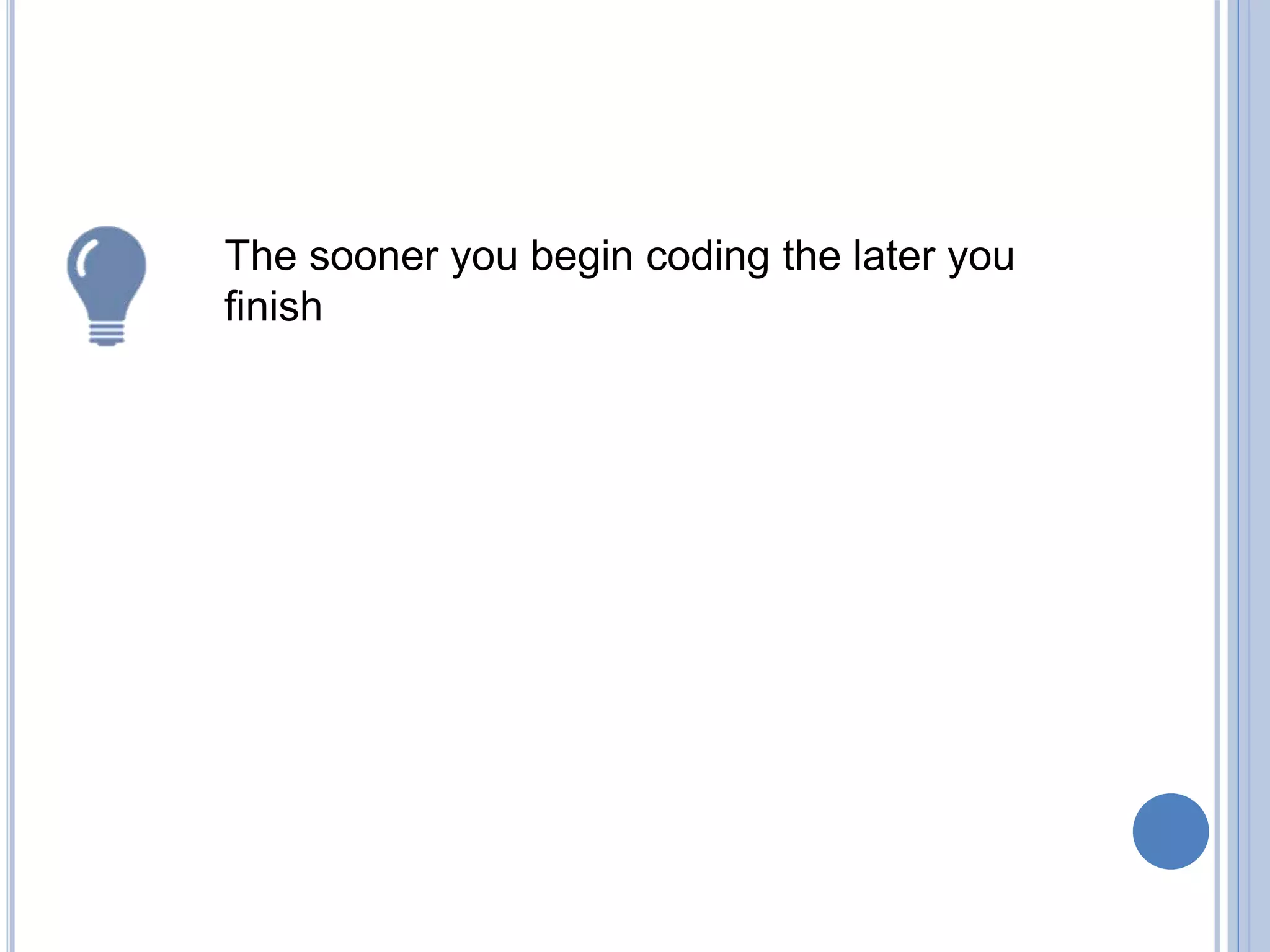

The sooner you begin coding the later you
finish

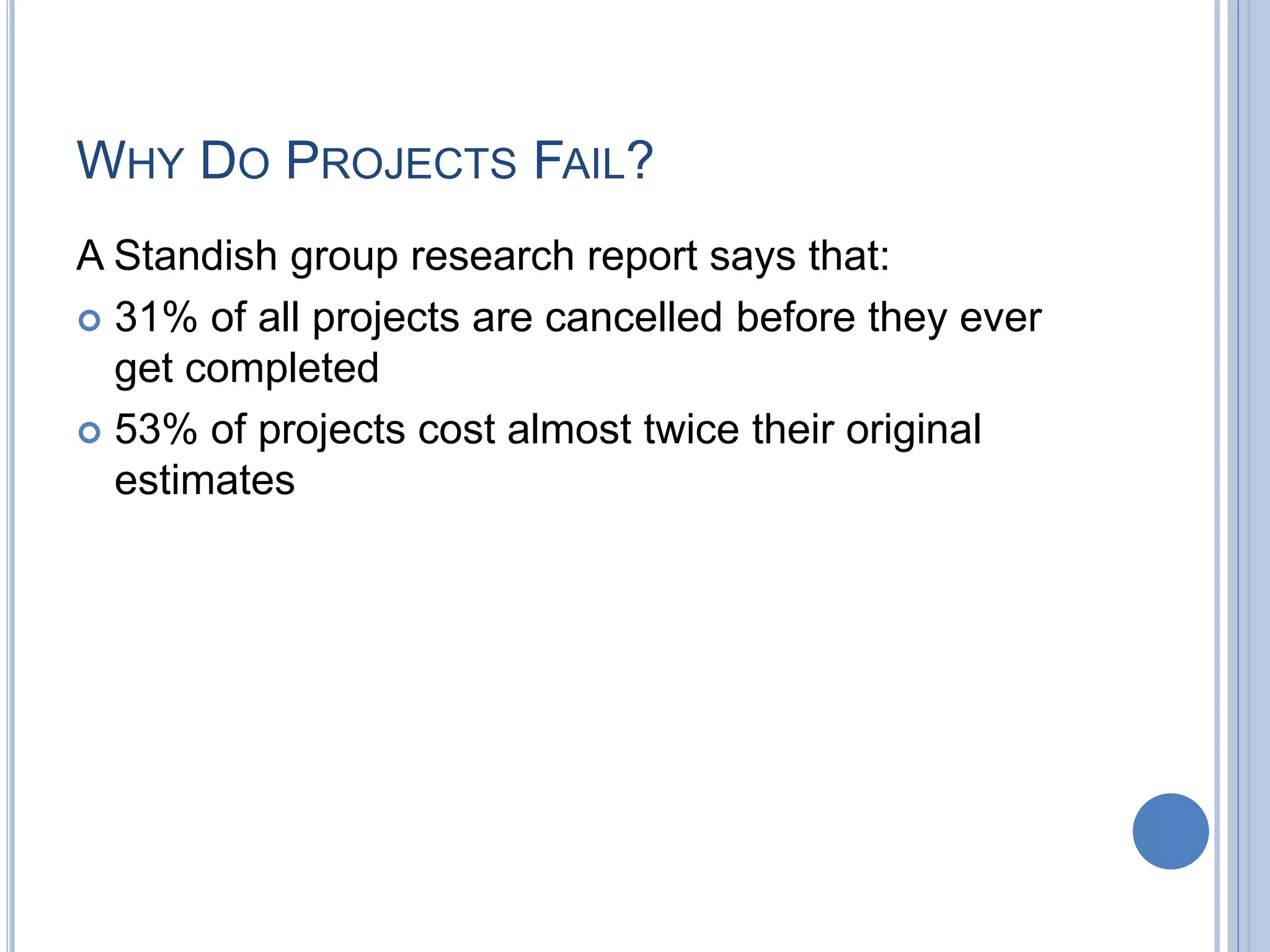

WHY DO PROJECTS FAIL?
A Standish group research report says that:
 31% of all projects are cancelled before they ever
get completed
 53% of projects cost almost twice their original
estimates

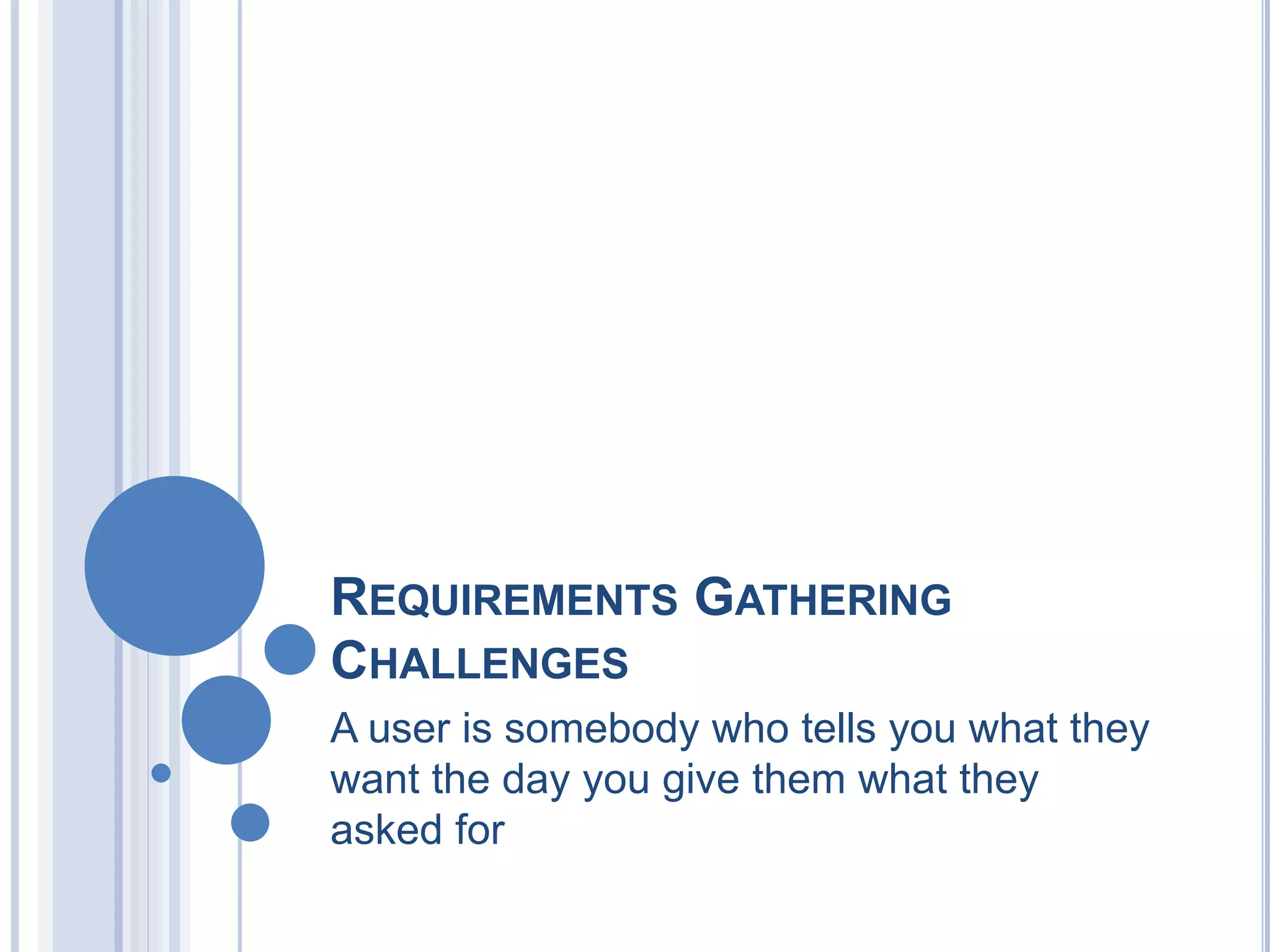

REQUIREMENTS GATHERING
CHALLENGES
A user is somebody who tells you what they
want the day you give them what they
asked for

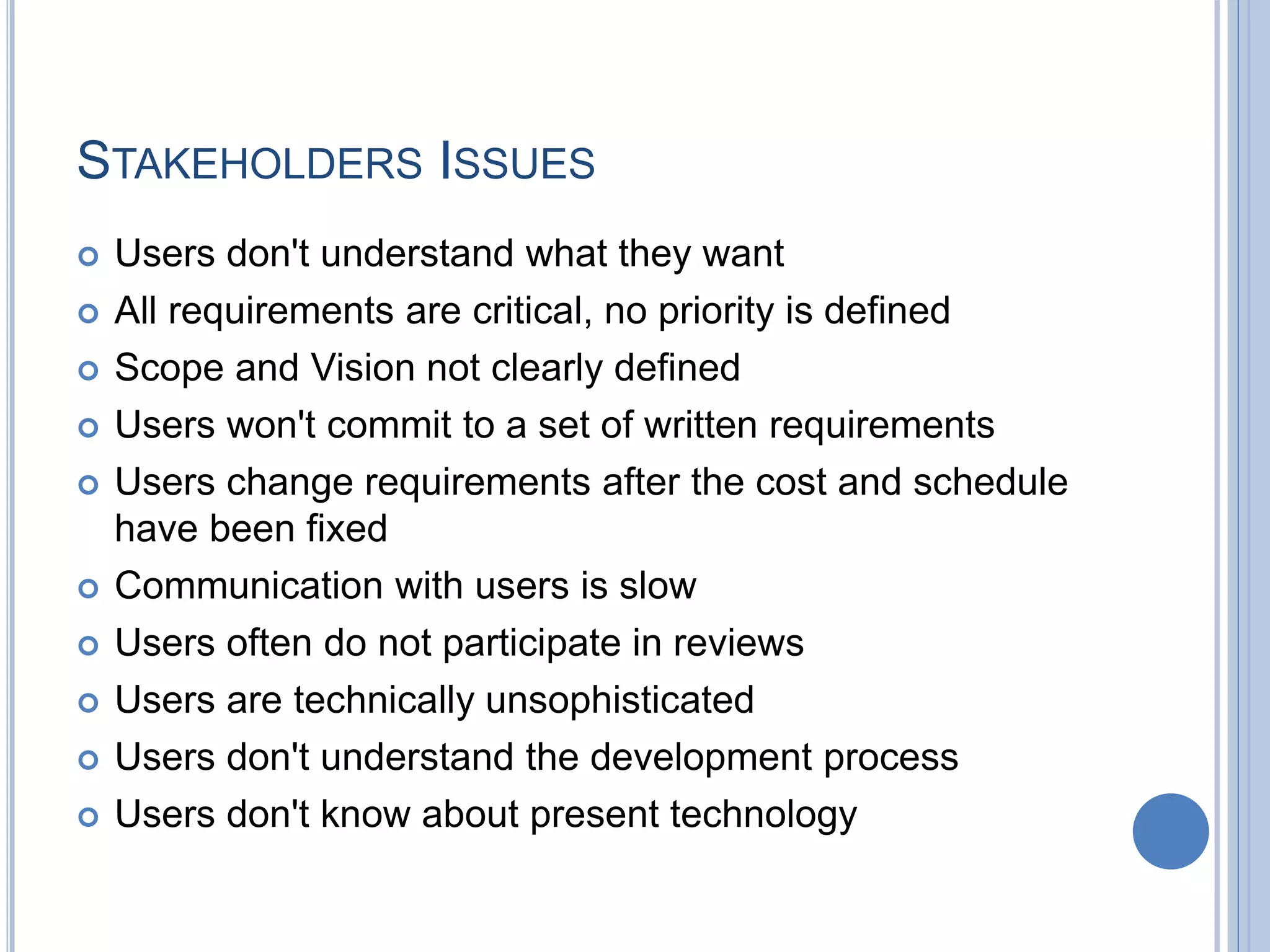

STAKEHOLDERS ISSUES
 Users don't understand what they want
 All requirements are critical, no priority is defined
 Scope and Vision not clearly defined
 Users won't commit to a set of written requirements
 Users change requirements after the cost and schedule
have been fixed
 Communication with users is slow
 Users often do not participate in reviews
 Users are technically unsophisticated
 Users don't understand the development process
 Users don't know about present technology

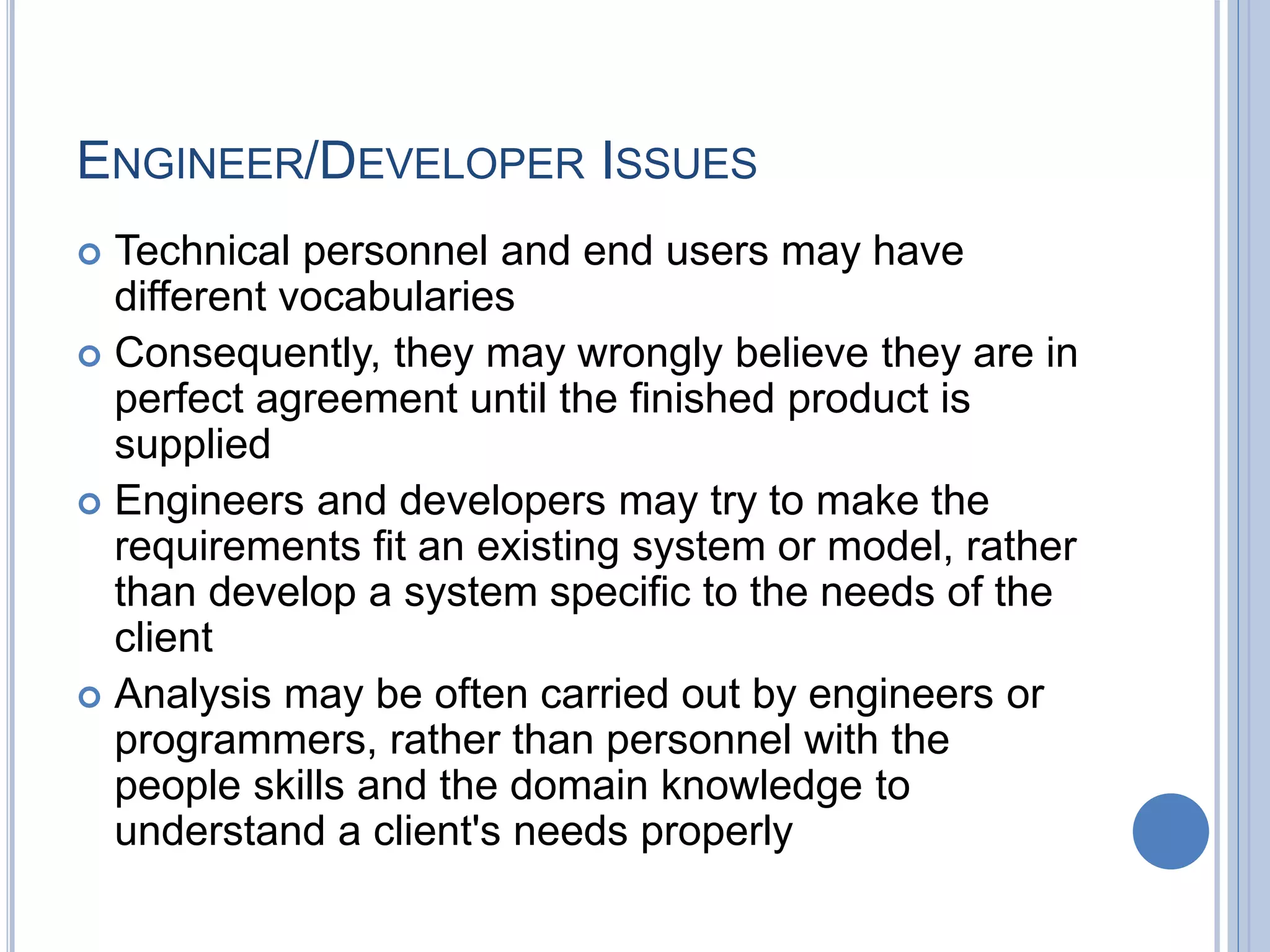

ENGINEER/DEVELOPER ISSUES
 Technical personnel and end users may have
different vocabularies
 Consequently, they may wrongly believe they are in
perfect agreement until the finished product is
supplied
 Engineers and developers may try to make the
requirements fit an existing system or model, rather
than develop a system specific to the needs of the
client
 Analysis may be often carried out by engineers or
programmers, rather than personnel with the
people skills and the domain knowledge to
understand a client's needs properly

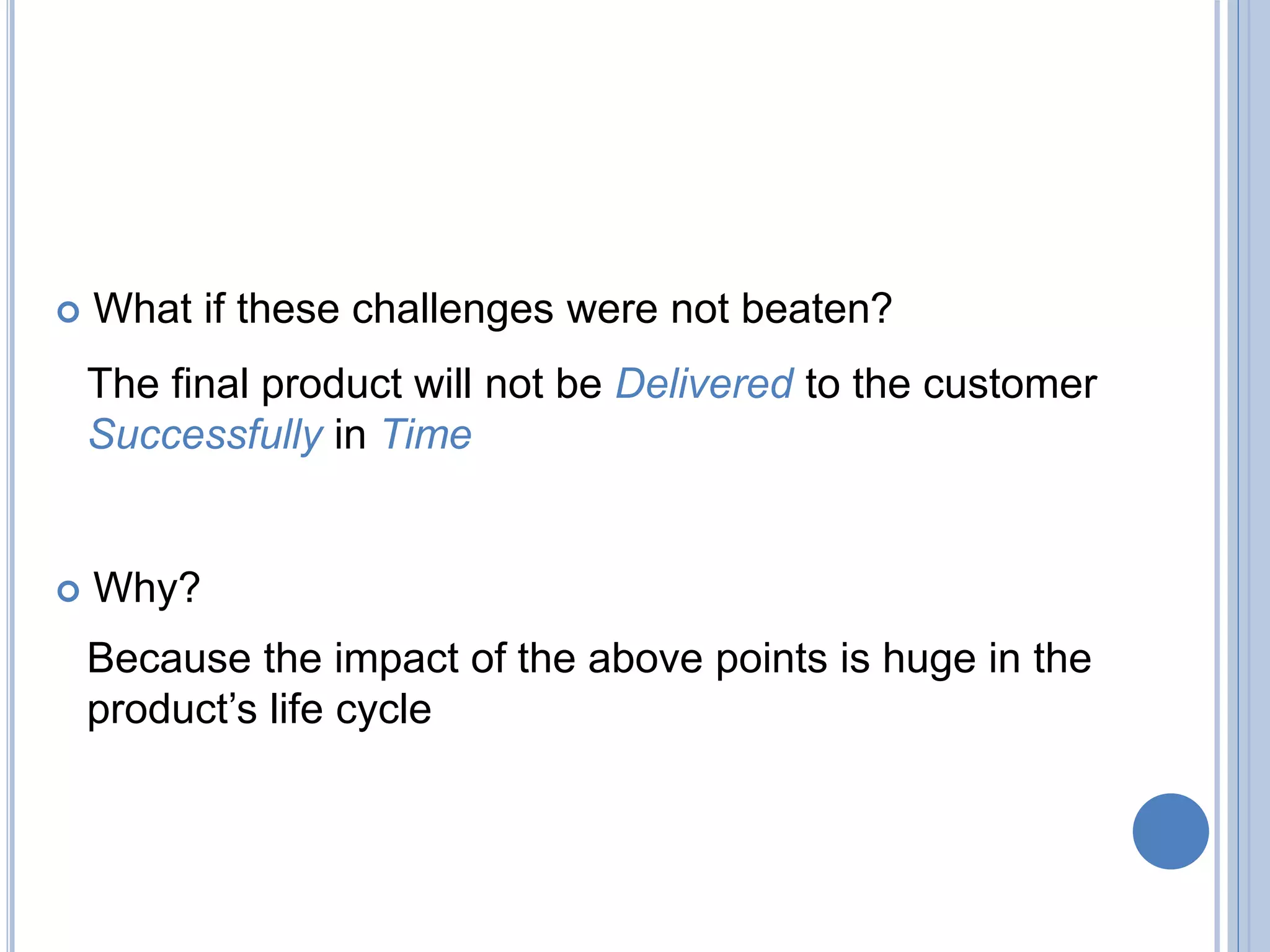

 What if these challenges were not beaten?
The final product will not be Delivered to the customer
Successfully in Time
 Why?
Because the impact of the above points is huge in the
product’s life cycle
“What if users developed their own applications?!”
What is not on paper has not been said

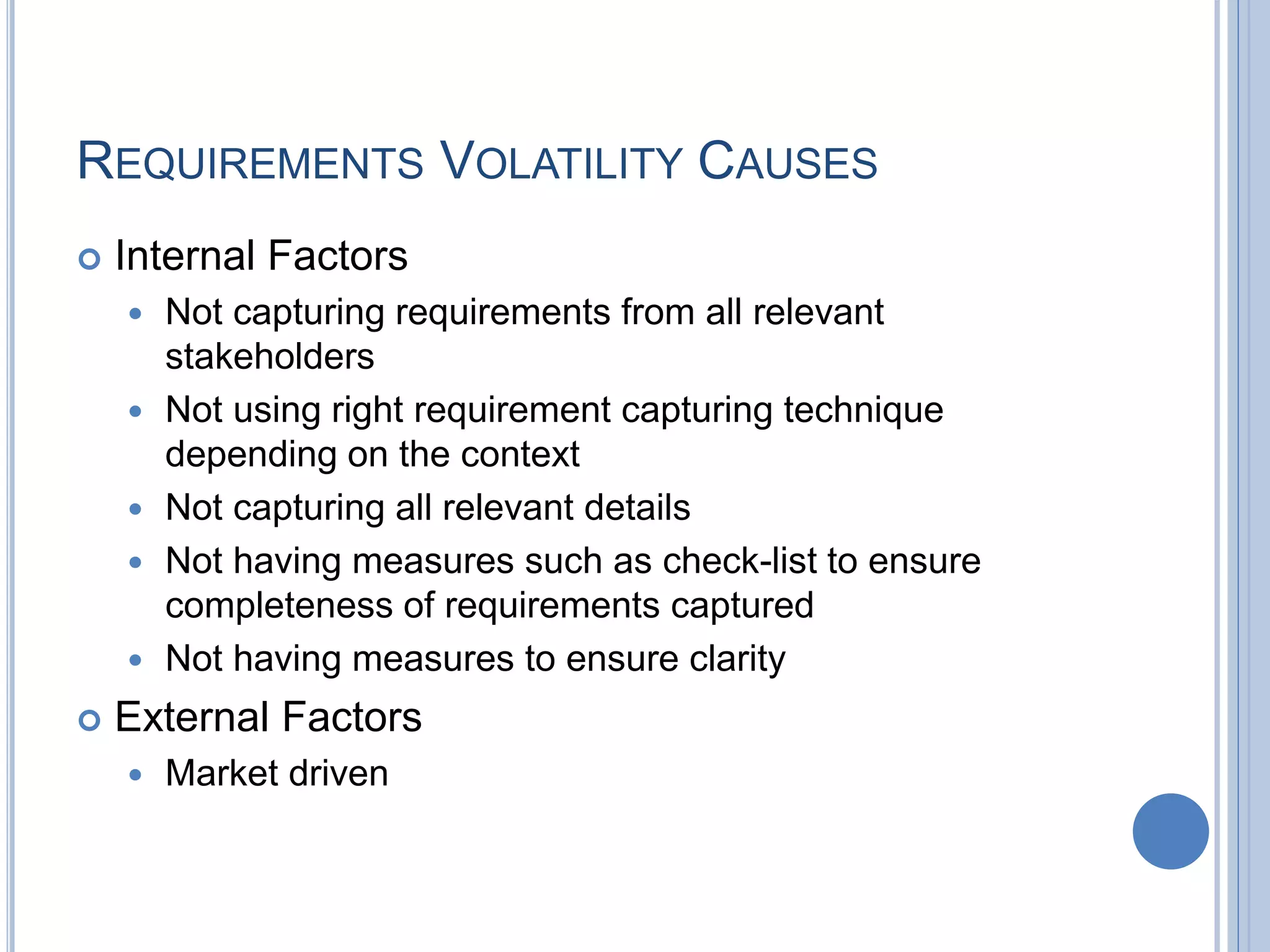

REQUIREMENTS VOLATILITY CAUSES
 Internal Factors
 Not capturing requirements from all relevant
stakeholders
 Not using right requirement capturing technique
depending on the context
 Not capturing all relevant details
 Not having measures such as check-list to ensure
completeness of requirements captured
 Not having measures to ensure clarity
 External Factors
 Market driven

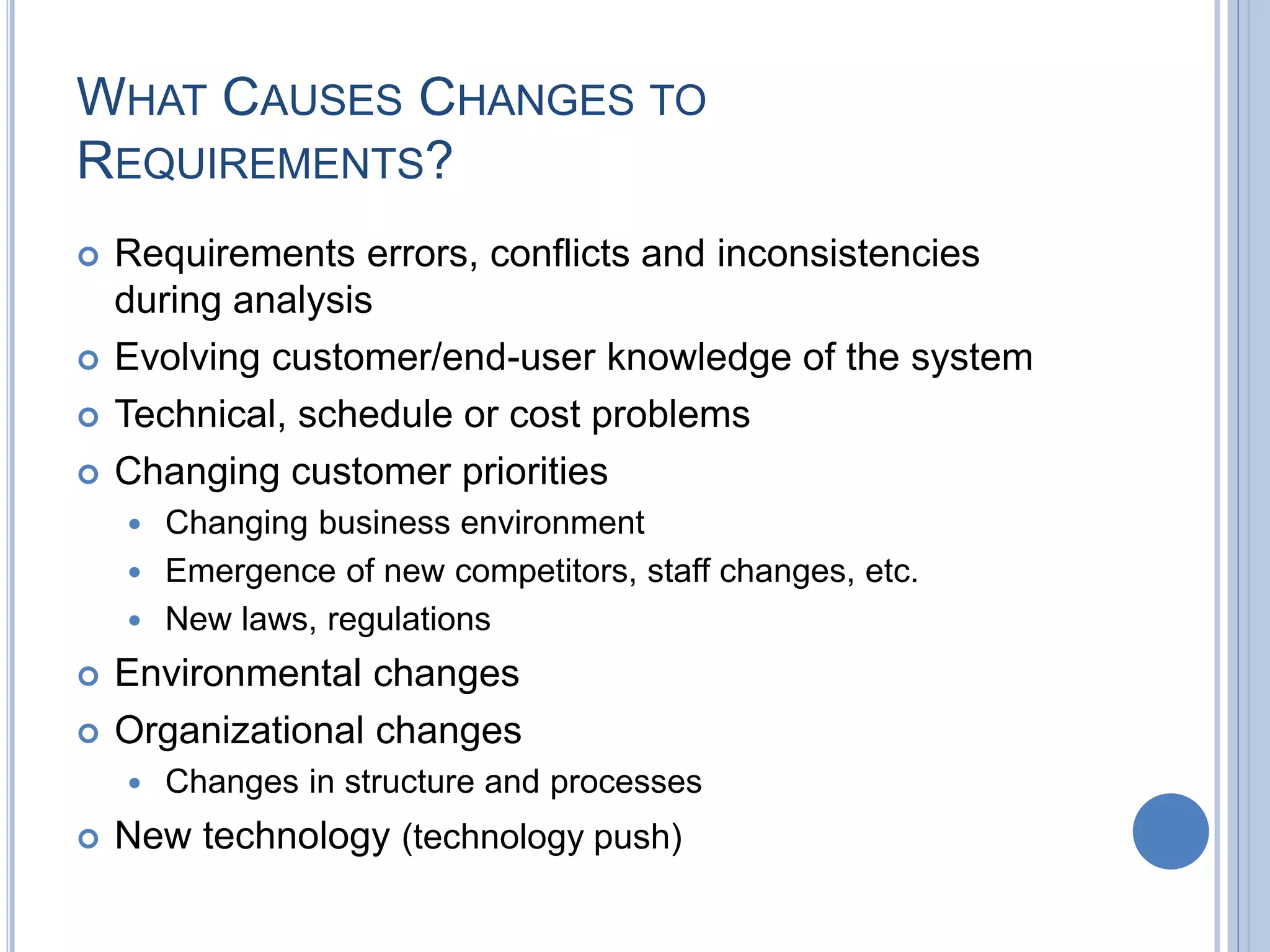

WHAT CAUSES CHANGES TO
REQUIREMENTS?
 Requirements errors, conflicts and inconsistencies
during analysis
 Evolving customer/end-user knowledge of the system
 Technical, schedule or cost problems
 Changing customer priorities
 Changing business environment
 Emergence of new competitors, staff changes, etc.
 New laws, regulations
 Environmental changes
 Organizational changes
 Changes in structure and processes
 New technology (technology push)
SCOPE CREEP
 Refers to uncontrolled changes or continuous
growth in a project's scope
 This can occur when the scope of a project is not
properly defined, documented, or controlled
 It is generally considered harmful
WHO IS THE BUSINESS ANALYST?
The Analyst Job
Responsibilities
Business Analyst Qualifications

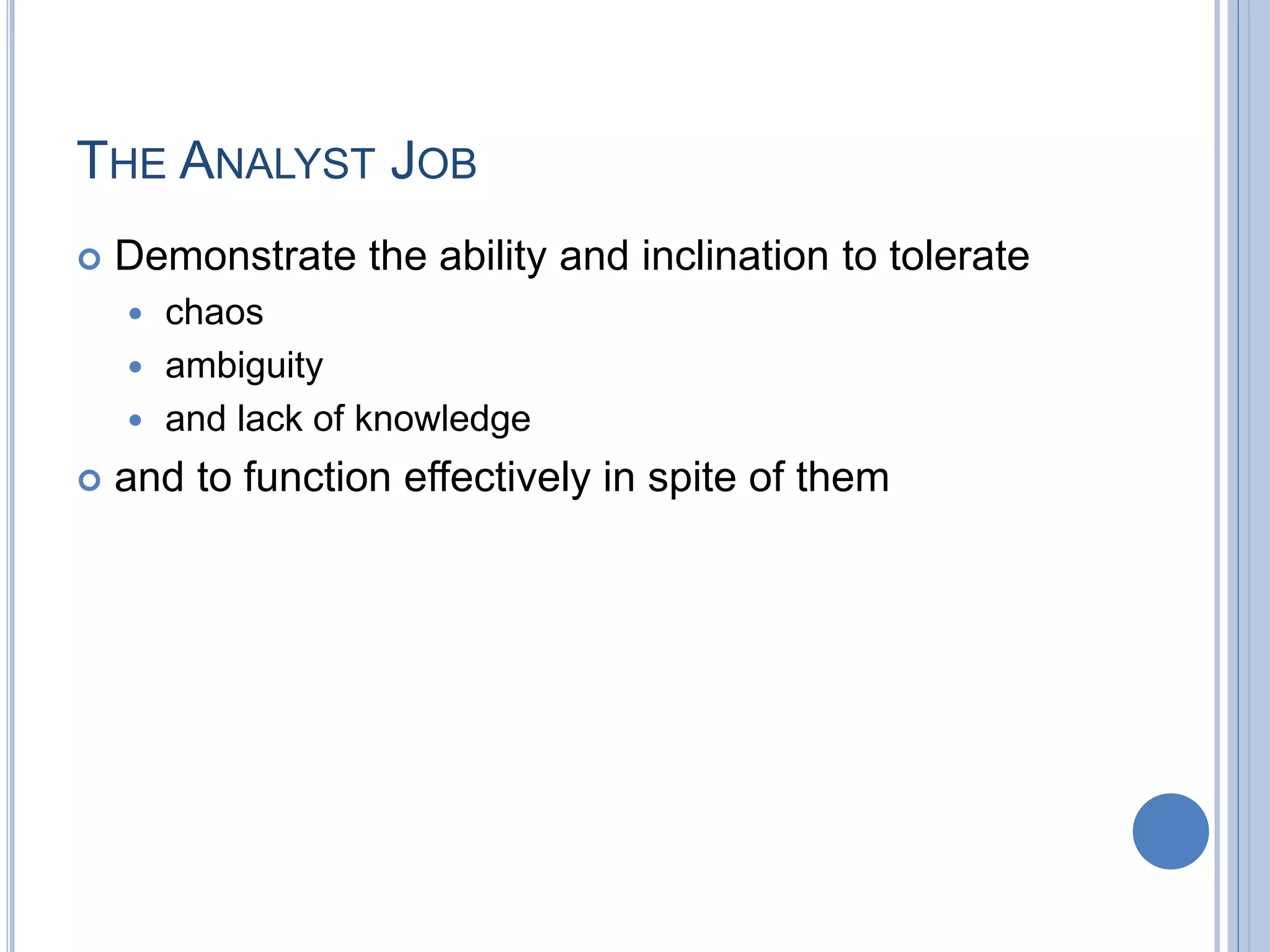

THE ANALYST JOB
 Demonstrate the ability and inclination to tolerate
 chaos
 ambiguity
 and lack of knowledge
 and to function effectively in spite of them
RESPONSIBILITIES
Help businesses implement technology solutions in a
cost-effective way by:
 Understanding business change needs
 Assessing the business impact of those changes
 Capturing, analyzing and documenting
requirements
 Supporting the communication and delivery of
requirements with relevant stakeholders
I know that you believe that you understand what you
think I said but I am not sure you realize that what
you heard is not what I meant
BUSINESS ANALYST QUALIFICATIONS
Technical
Analytical
Business
Management
Communication

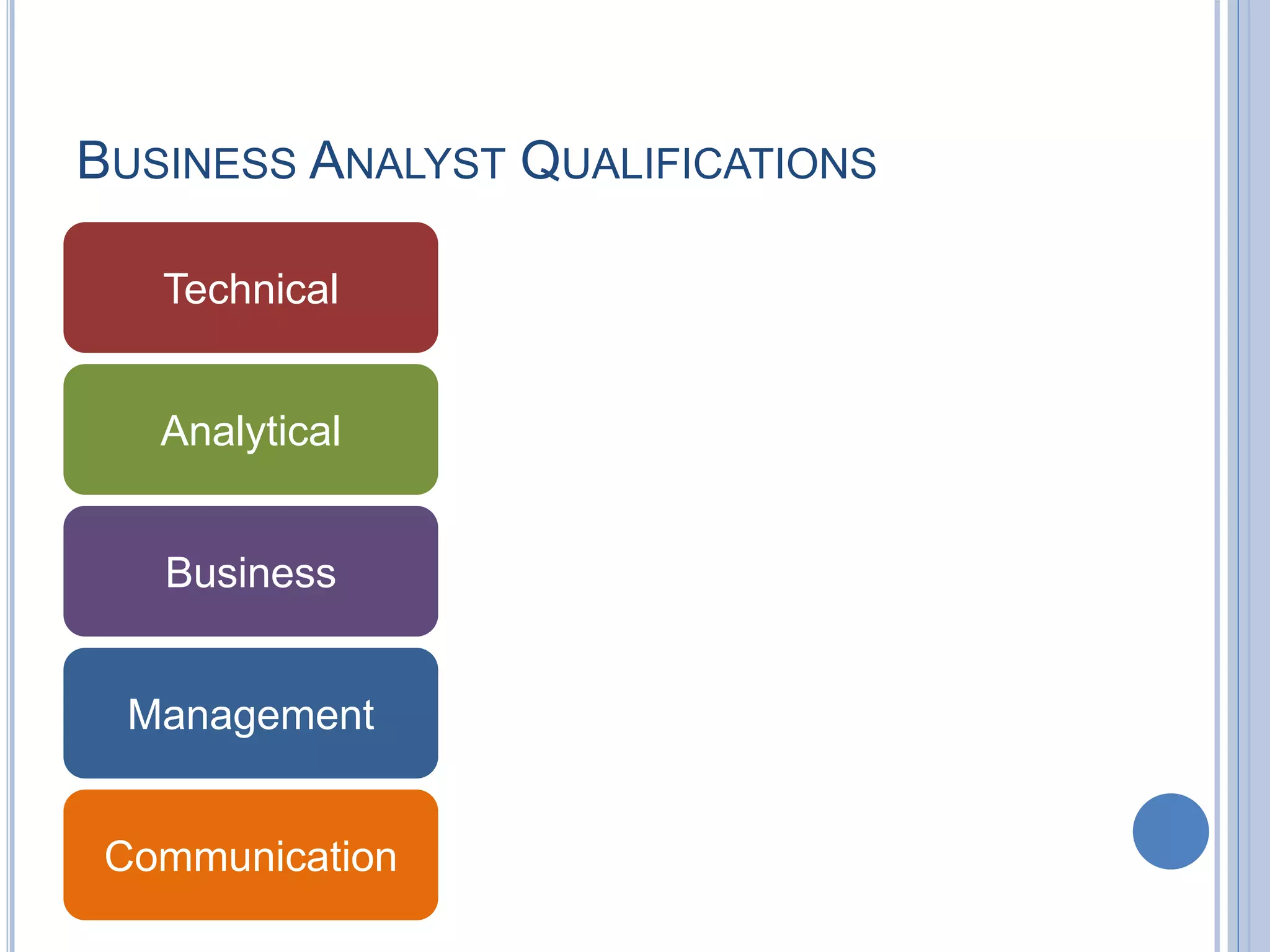

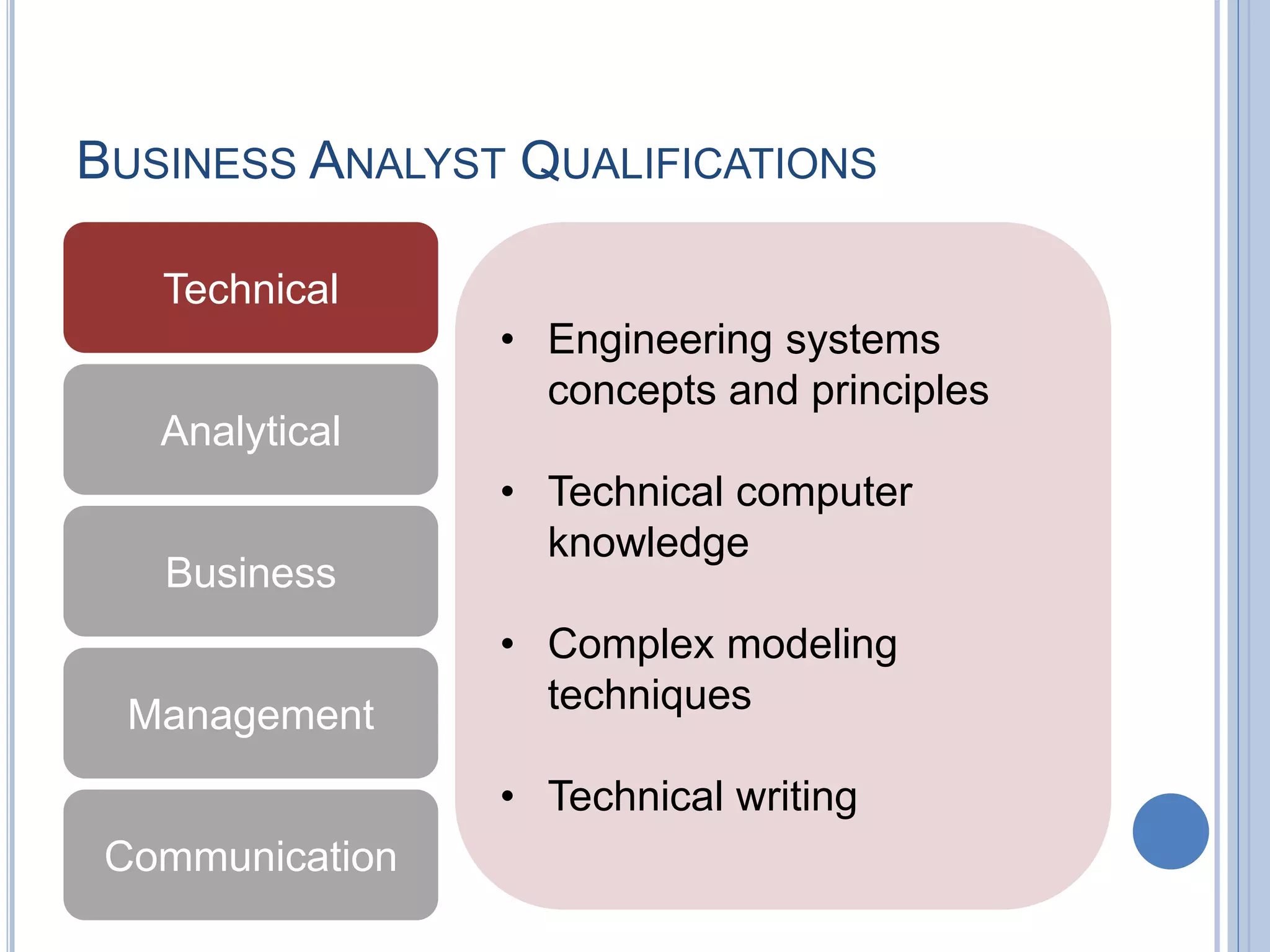

BUSINESS ANALYST QUALIFICATIONS
Technical
Analytical
Business
Management
Communication
• Engineering systems
concepts and principles
• Technical computer
knowledge
• Complex modeling
techniques
• Technical writing

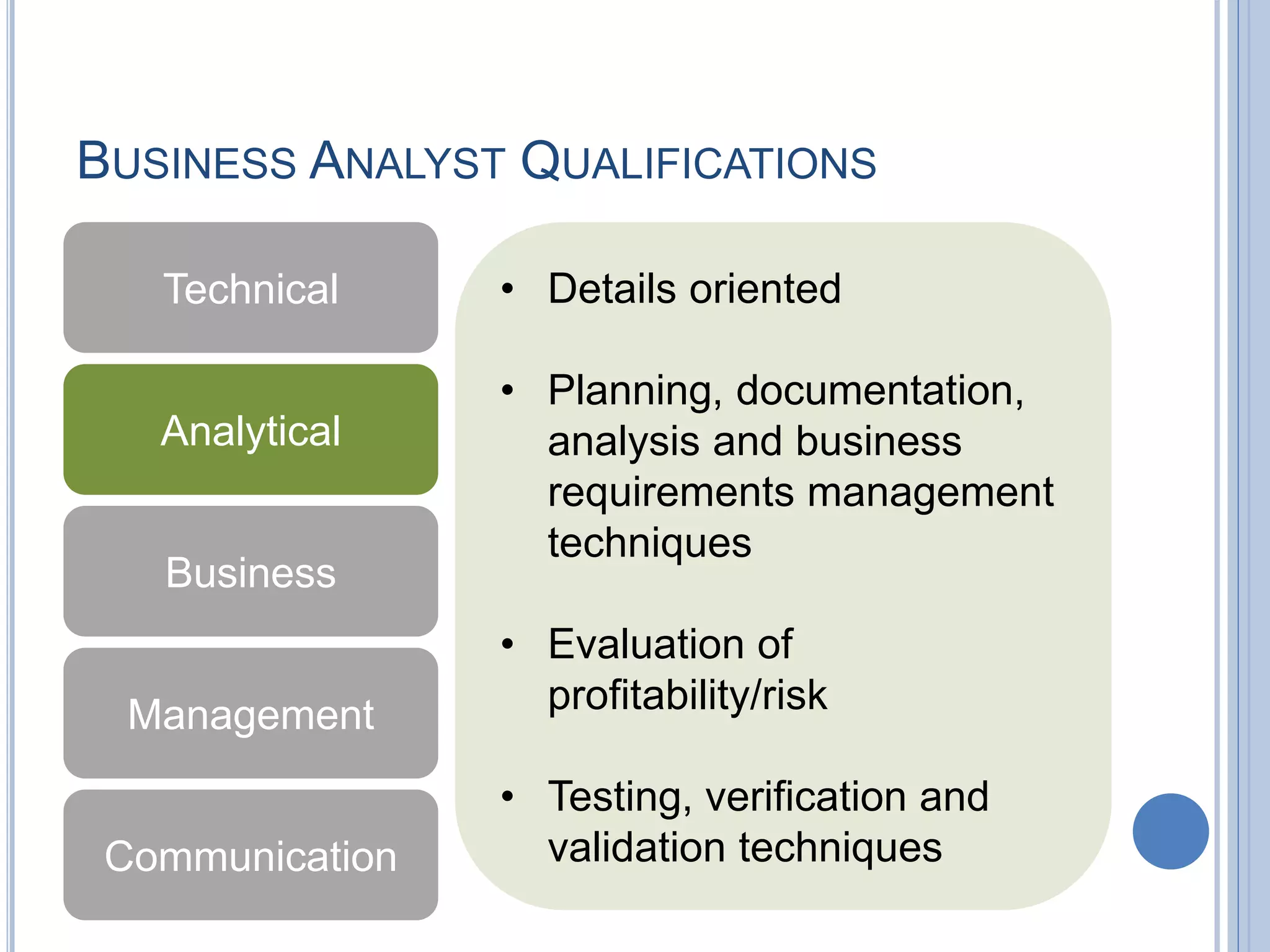

BUSINESS ANALYST QUALIFICATIONS
Technical
Analytical
Business
Management
Communication
• Details oriented
• Planning, documentation,
analysis and business
requirements management
techniques
• Evaluation of
profitability/risk
• Testing, verification and
validation techniques
BUSINESS ANALYST QUALIFICATIONS
Technical
Analytical
Business
Management
Communication

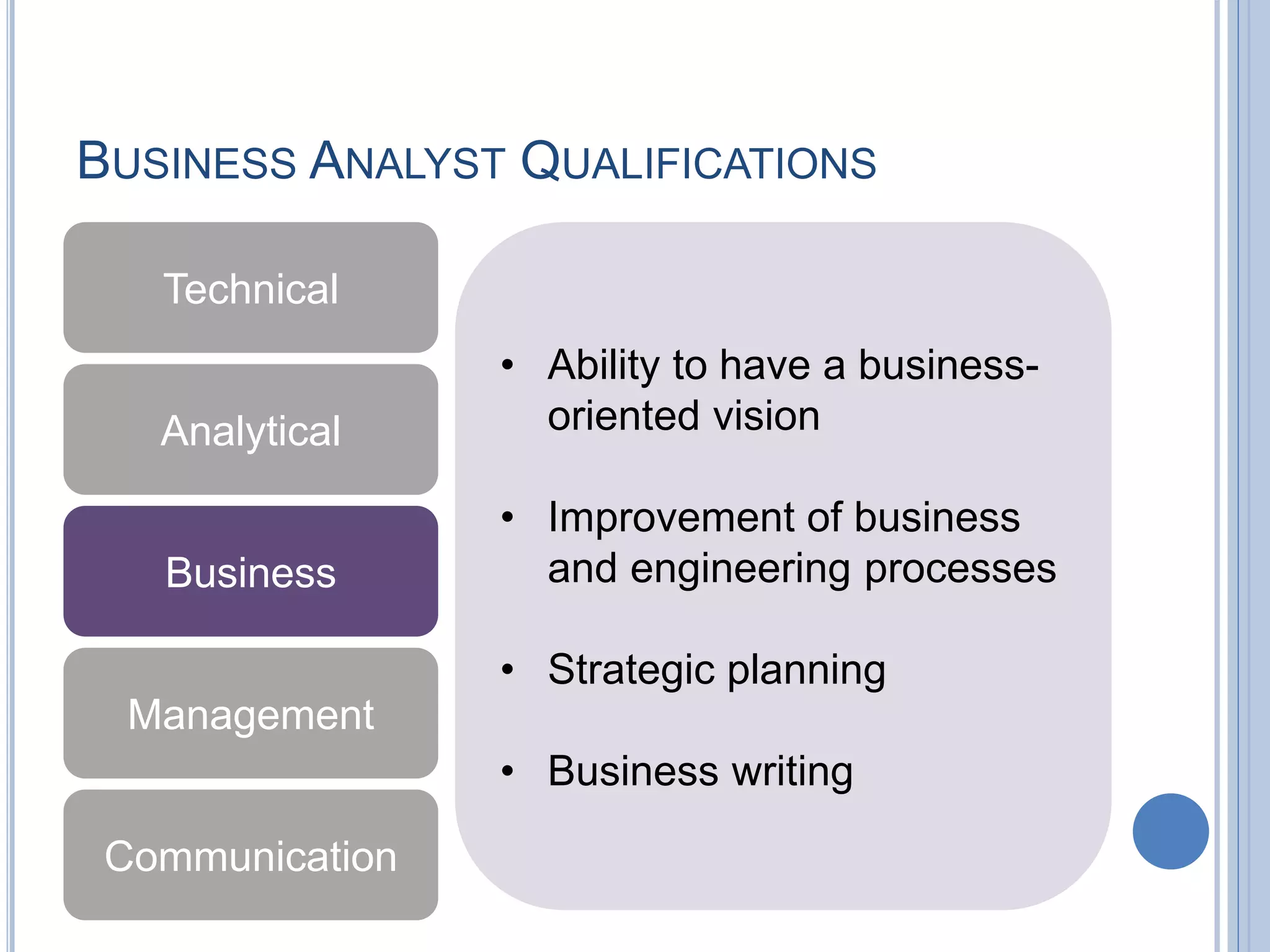

• Ability to have a business-
oriented vision
• Improvement of business
and engineering processes
• Strategic planning
• Business writing
BUSINESS ANALYST QUALIFICATIONS
Technical
Analytical
Business
Management
Communication

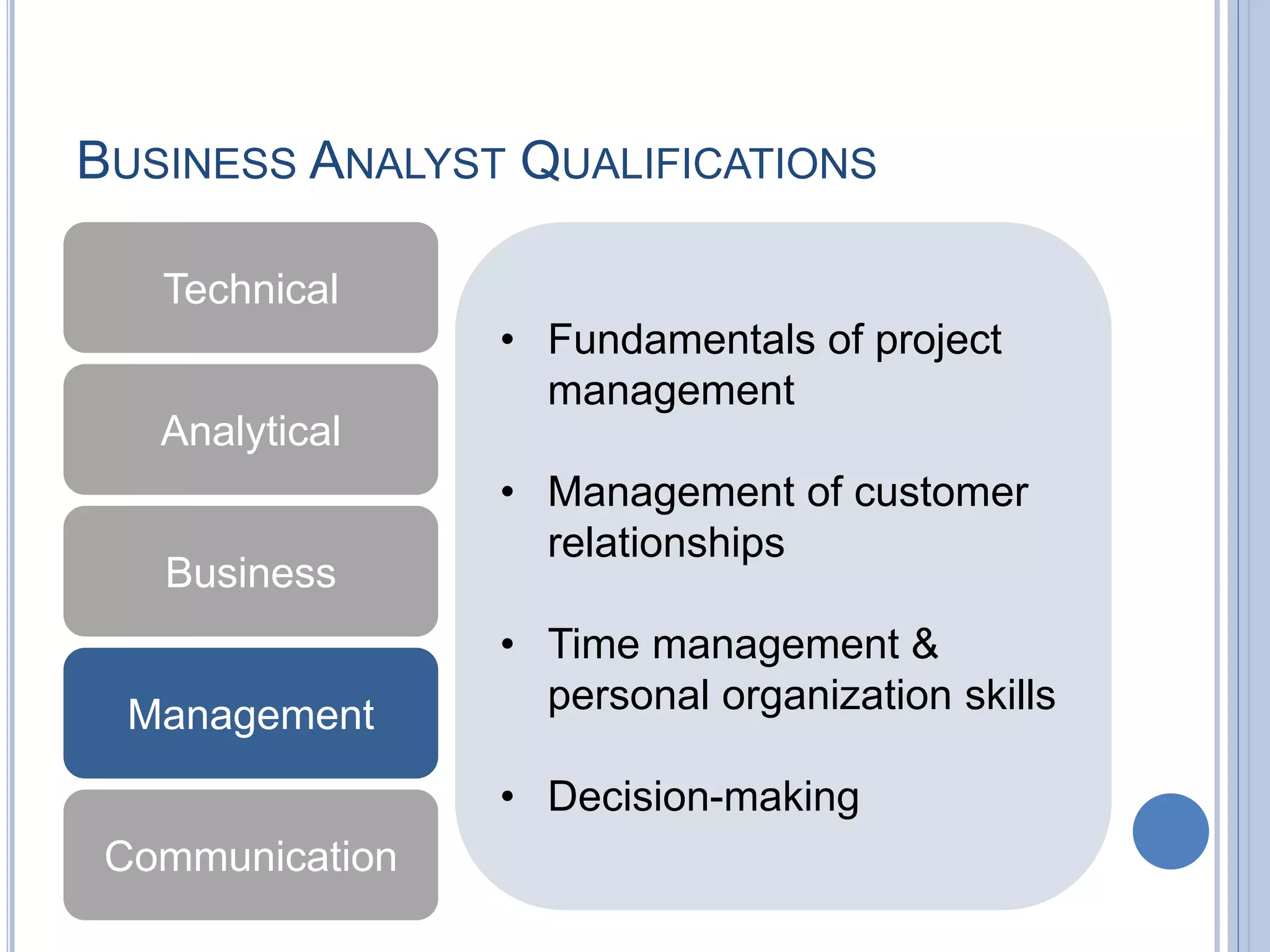

• Fundamentals of project
management
• Management of customer
relationships
• Time management &
personal organization skills
• Decision-making
BUSINESS ANALYST QUALIFICATIONS
Technical
Analytical
Business
Management

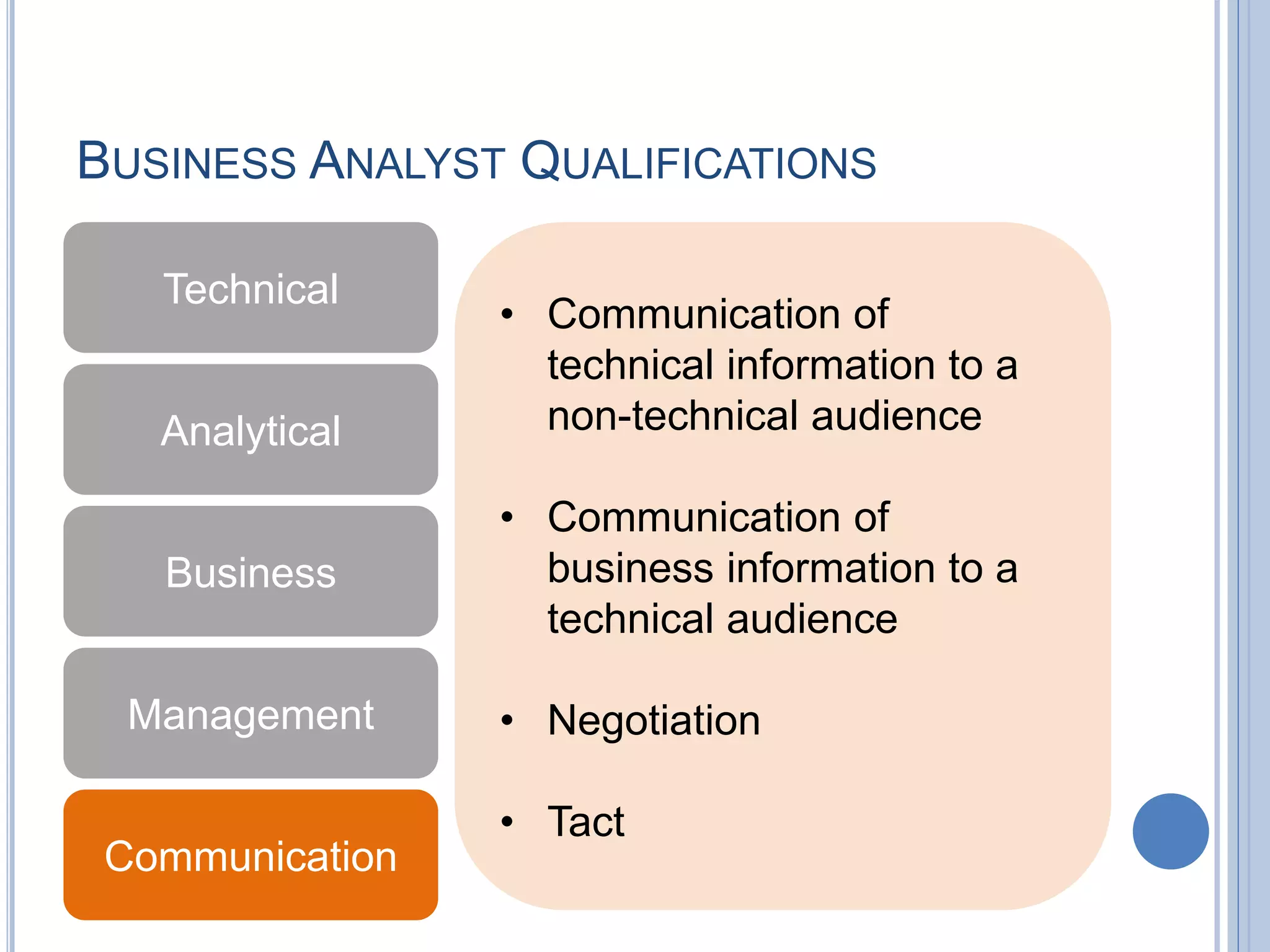

Communication
• Communication of
technical information to a
non-technical audience
• Communication of
business information to a
technical audience
• Negotiation
• Tact
HOW TO DO THE JOB?
Software Development Lifecycle (SDLC)
Requirements Management Process
Requirements Gathering Activities
Change Management

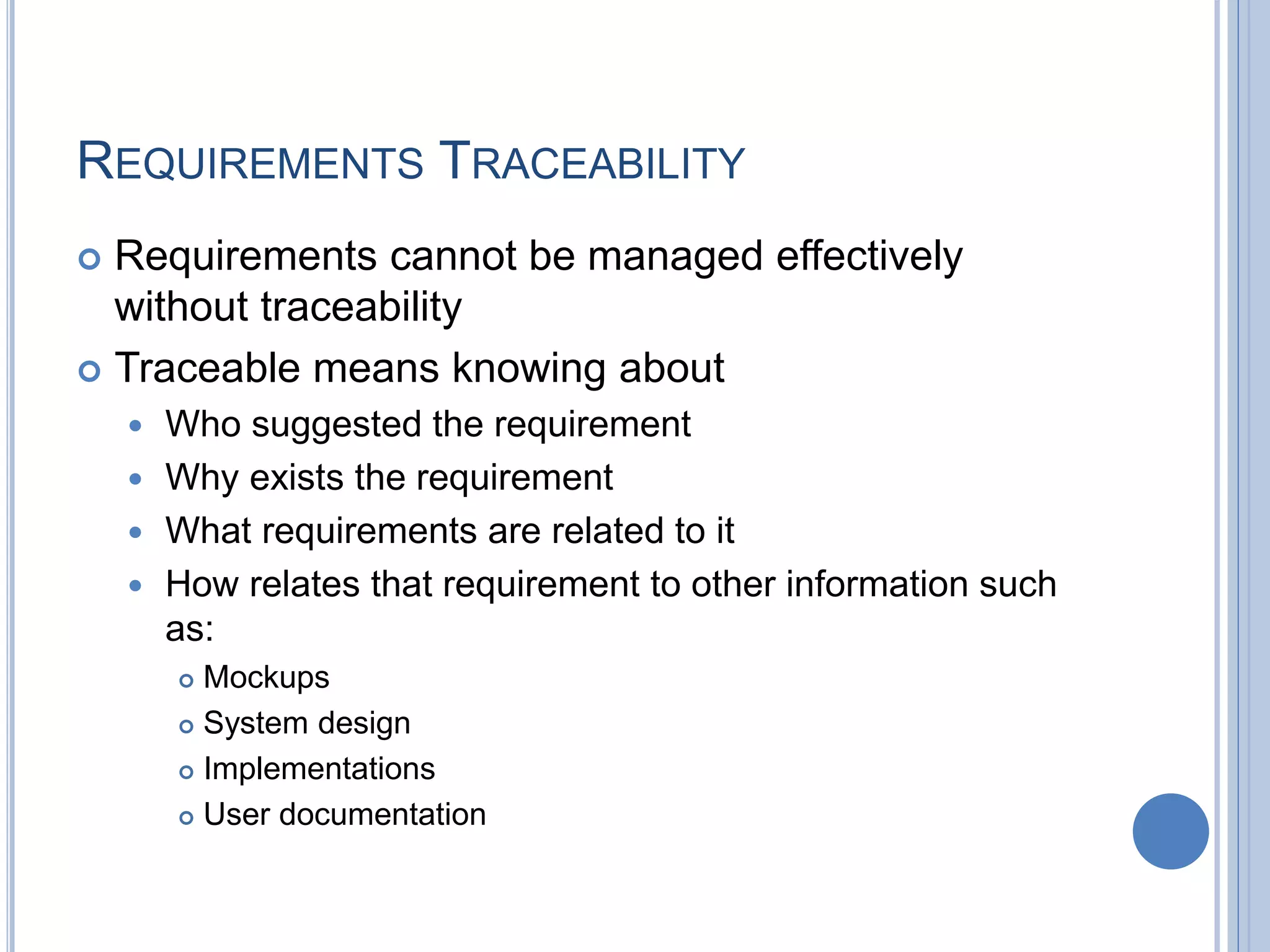

Requirements Traceability
Signoff

SOFTWARE DEVELOPMENT LIFECYCLE (SDLC)

REQUIREMENTS MANAGEMENT PROCESS
Elicitation
Analysis
Recording
Validation
Change Management
Traceability
Signoff
REQUIREMENTS GATHERING ACTIVITIES
Eliciting Requirements
Communicating with users to determine their requirements
Analyzing Requirements
Determining whether the stated requirements are unclear, incomplete,
ambiguous, or contradictory and then resolving these issues
Recording Requirements
Requirements may be documented in various forms
 Natural-language documents
 Use cases
 User stories
 Process specifications
Validating Requirements
Checking that a product, service, or system meets requirements and that it
fulfills its intended purpose
A user will tell you anything you ask about,
but nothing more
CHANGE MANAGEMENT
 The process of managing the changes to
requirements
 Hard problem because of continuous changes
during development process
 The principal concerns are
 Managing the relationships between requirements
 Managing priorities between requirements
 Managing changes to agreed requirements
 Managing the dependencies between different
documents
 requirements document
 other documents produced in the systems engineering process
REQUIREMENTS TRACEABILITY
 Requirements cannot be managed effectively
without traceability
 Traceable means knowing about
 Who suggested the requirement
 Why exists the requirement
 What requirements are related to it
 How relates that requirement to other information such
as:
 Mockups
 System design
 Implementations
 User documentation
SIGNOFF
 Final & most important step in requirements
gathering process
 Requirements should be freezed
 Later request for changes should be treated
separately
 Technical opinion should be involved
 Review with customer before signoff
REQUIREMENTS GATHERING
TECHNIQUES
Requirements are the What
Design is the How
REQUIREMENTS GATHERING TECHNIQUES
 4 out of 5 software development projects go over
time, over budget or don’t deliver expected results
 Poor requirements account for 71% of software
project failures
 It pays to put in the effort upfront to minimize the
risk of failure
 The question is, how do we achieve this?
 There is no perfect method for gathering and analyzing
requirements
 If there was, we'd all be using it
 Rather, there are many approaches to choose from…

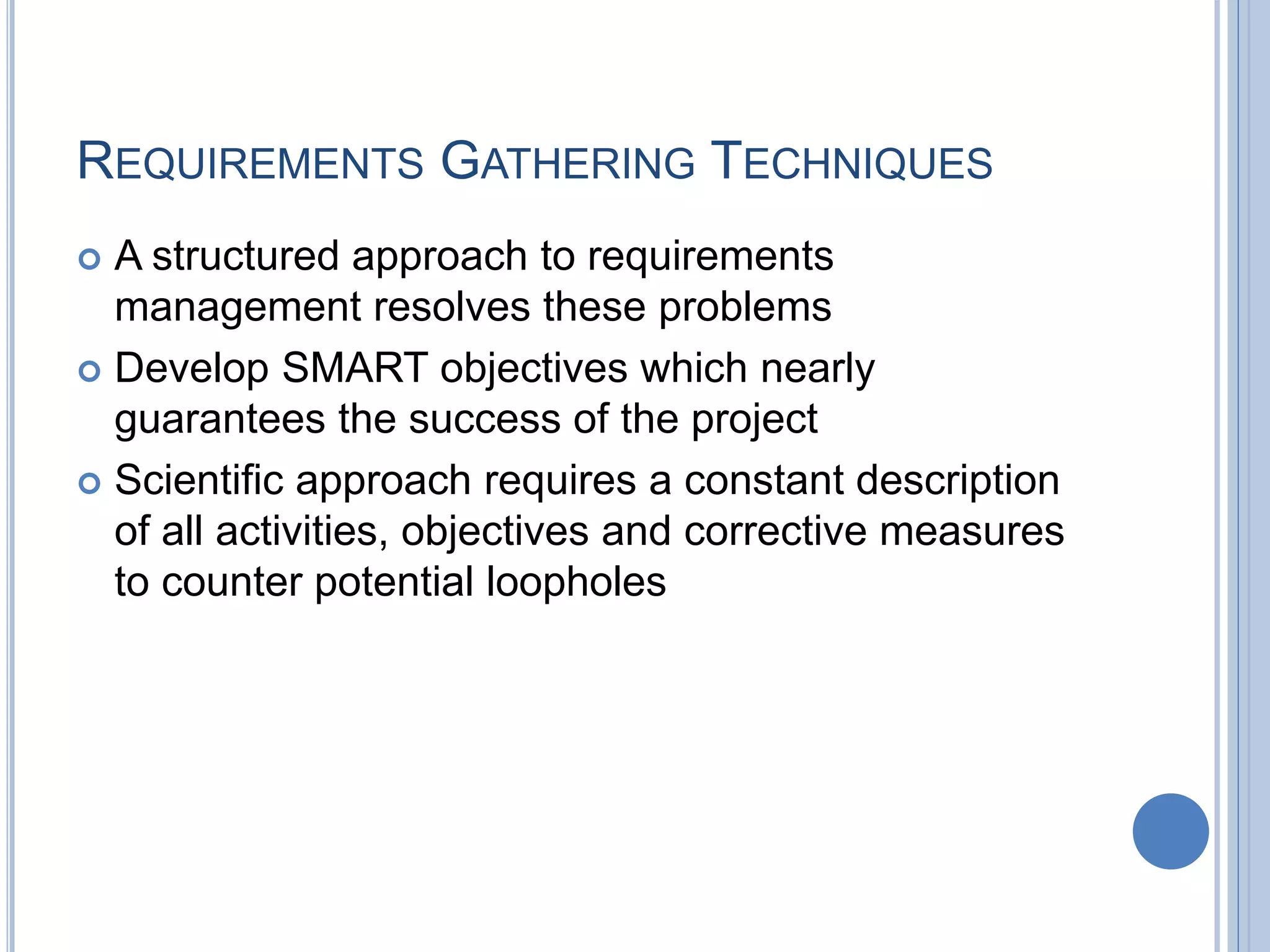

REQUIREMENTS GATHERING TECHNIQUES
 A structured approach to requirements
management resolves these problems
 Develop SMART objectives which nearly
guarantees the success of the project
 Scientific approach requires a constant description
of all activities, objectives and corrective measures
to counter potential loopholes
REQUIREMENTS GATHERING TECHNIQUES
 Apprenticing Technique
Observes the
business users
Understands the day
to day activities
Capture/documents
the requirements
Get signoff from
customer
REQUIREMENTS GATHERING TECHNIQUES

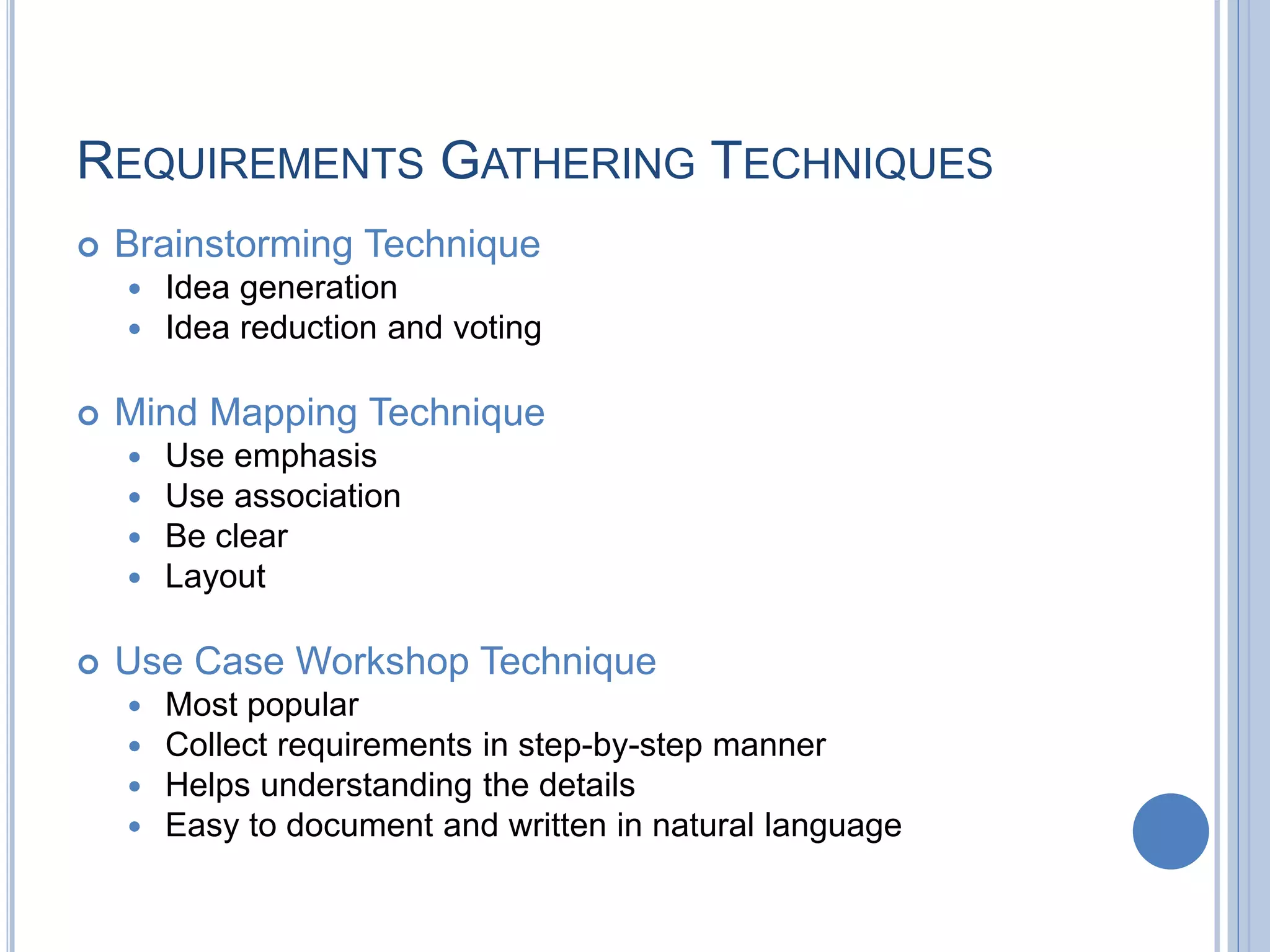

 Brainstorming Technique
 Idea generation
 Idea reduction and voting
 Mind Mapping Technique
 Use emphasis
 Use association
 Be clear
 Layout
 Use Case Workshop Technique
 Most popular
 Collect requirements in step-by-step manner
 Helps understanding the details
 Easy to document and written in natural language
REQUIREMENTS GATHERING TECHNIQUES

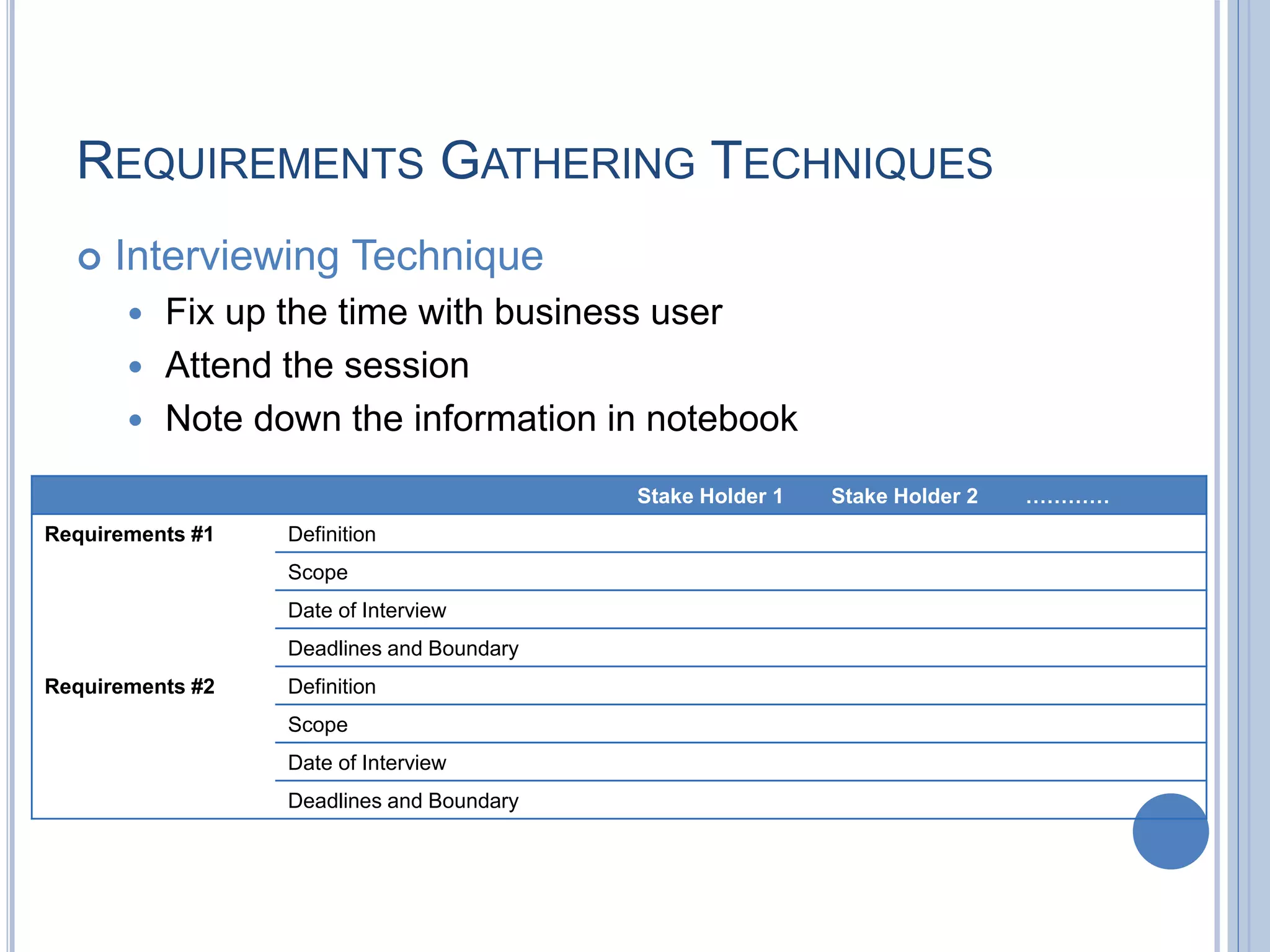

 Interviewing Technique
 Fix up the time with business user
 Attend the session
 Note down the information in notebook
Stake Holder 1 Stake Holder 2 …………
Requirements #1 Definition
Scope
Date of Interview
Deadlines and Boundary
Requirements #2 Definition
Scope
Date of Interview
Deadlines and Boundary
REQUIREMENTS GATHERING TECHNIQUES

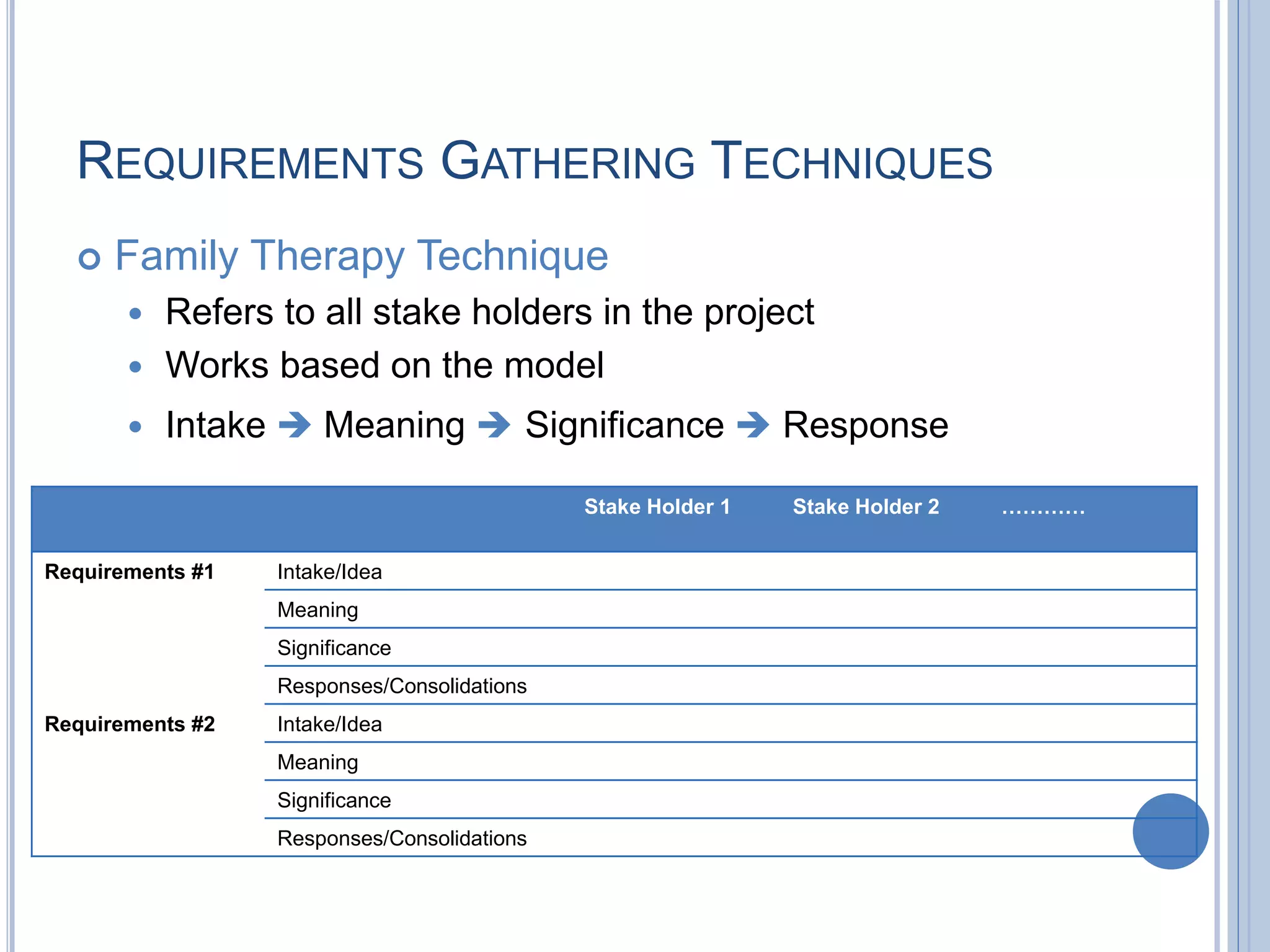

 Family Therapy Technique
 Refers to all stake holders in the project
 Works based on the model
 Intake  Meaning  Significance  Response
Stake Holder 1 Stake Holder 2 …………
Requirements #1 Intake/Idea
Meaning
Significance
Responses/Consolidations
Requirements #2 Intake/Idea
Meaning
Significance
Responses/Consolidations
REQUIREMENTS GATHERING TECHNIQUES

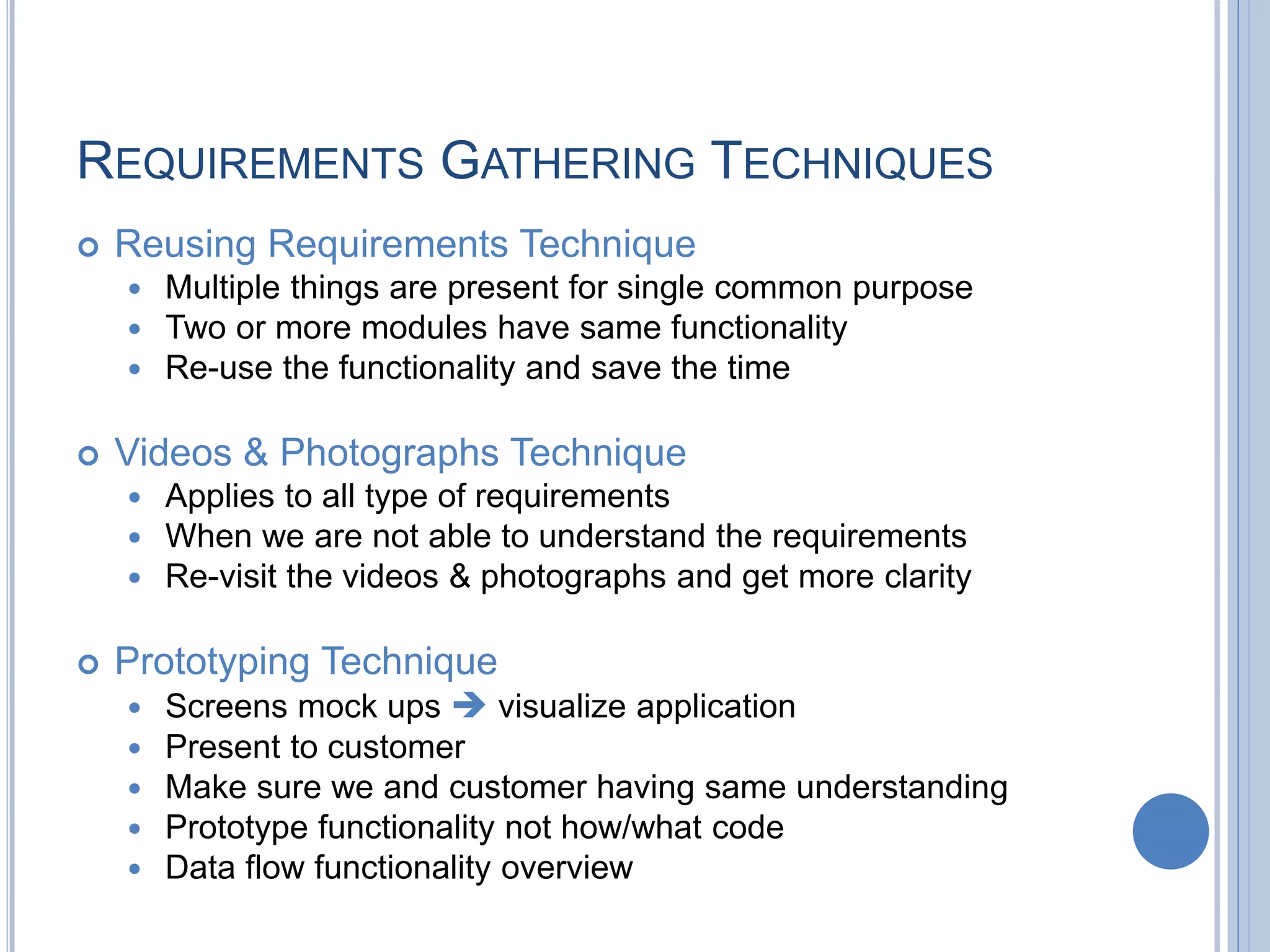

 Reusing Requirements Technique
 Multiple things are present for single common purpose
 Two or more modules have same functionality
 Re-use the functionality and save the time
 Videos & Photographs Technique
 Applies to all type of requirements
 When we are not able to understand the requirements
 Re-visit the videos & photographs and get more clarity
 Prototyping Technique
 Screens mock ups  visualize application
 Present to customer
 Make sure we and customer having same understanding
 Prototype functionality not how/what code
 Data flow functionality overview

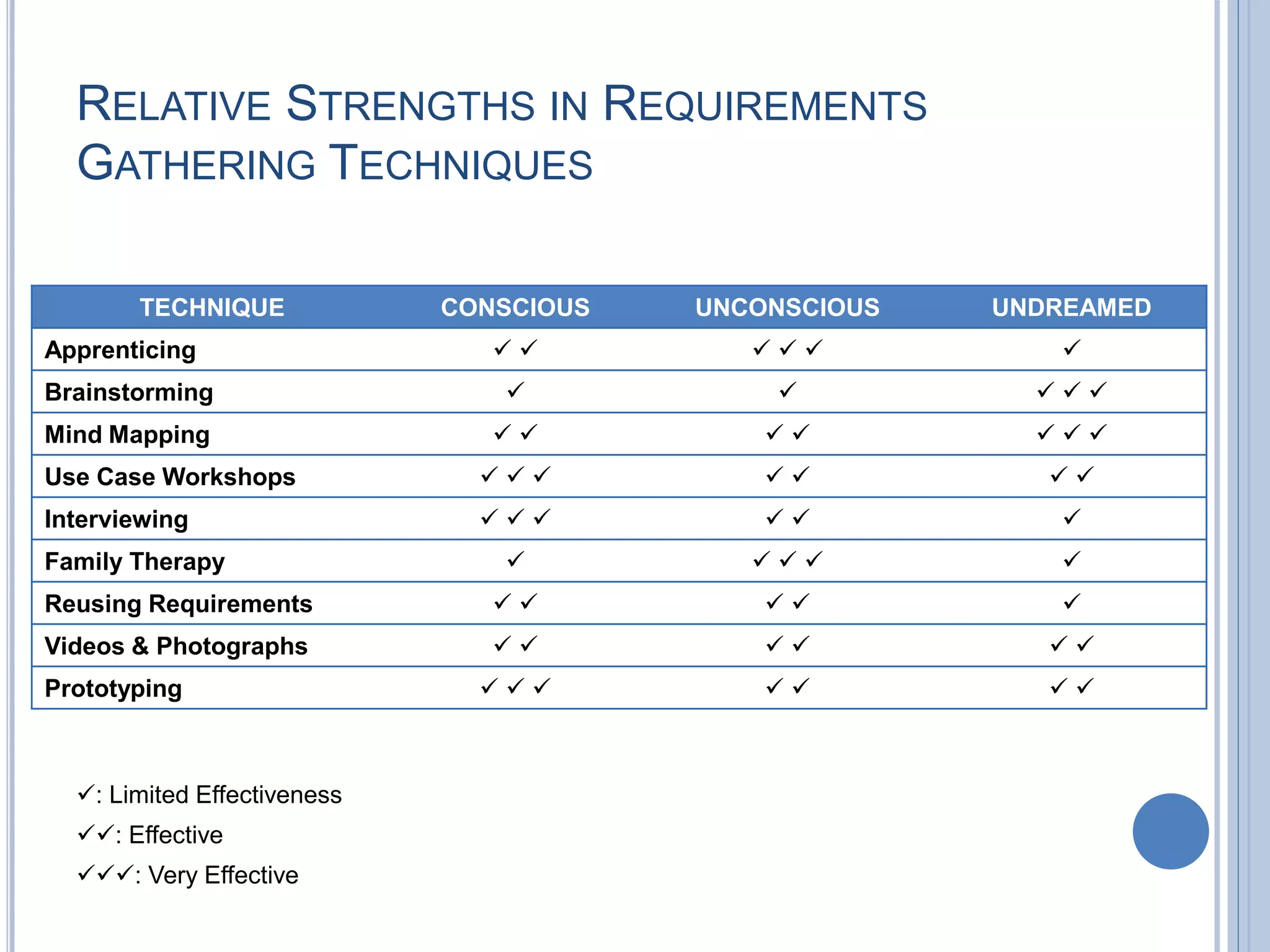

RELATIVE STRENGTHS IN REQUIREMENTS
GATHERING TECHNIQUES
: Limited Effectiveness
: Effective
: Very Effective
TECHNIQUE CONSCIOUS UNCONSCIOUS UNDREAMED
Apprenticing      
Brainstorming     
Mind Mapping       
Use Case Workshops       
Interviewing      
Family Therapy     
Reusing Requirements     
Videos & Photographs      
Prototyping       
HOW TO DOCUMENT
REQUIREMENTS?
Requirements Importance
Requirements Meaning
What Should the BA Record?
REQUIREMENTS IMPORTANCE
 Requirements Gathering is
about info transferring and sharing
 Requirements Document is
the project Contract between users & developers
 Requirements Document is
the first draft of the Project Plan
 Requirements Document is
used throughout the project from start to delivery by all
stakeholders (planning, designing, mockups, testing, acceptance)

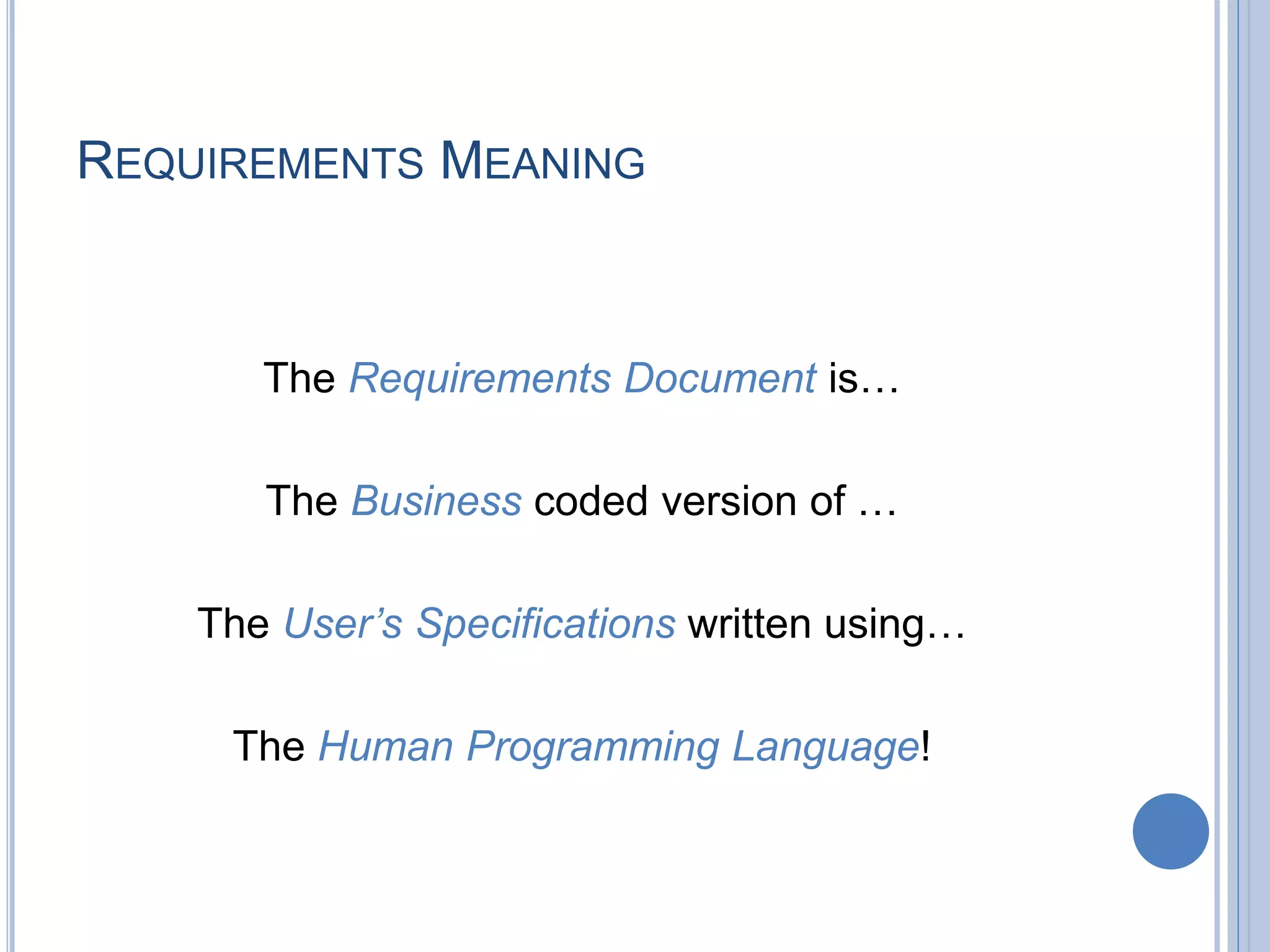

REQUIREMENTS MEANING
The Requirements Document is…
The Business coded version of …
The User’s Specifications written using…
The Human Programming Language!
WHAT SHOULD THE BA RECORD?
 Stakeholders
 Include stakeholders names, titles & signatures
 Role in requirements gathering
 Role in approval
 Problem Statement
 Brief idea about the purpose of the project
 Overview of problem background & impact of implementation
 Business Goals
 Helps developer and business stakeholders understanding
the goal of the project & sharing the same view
WHAT SHOULD THE BA RECORD?

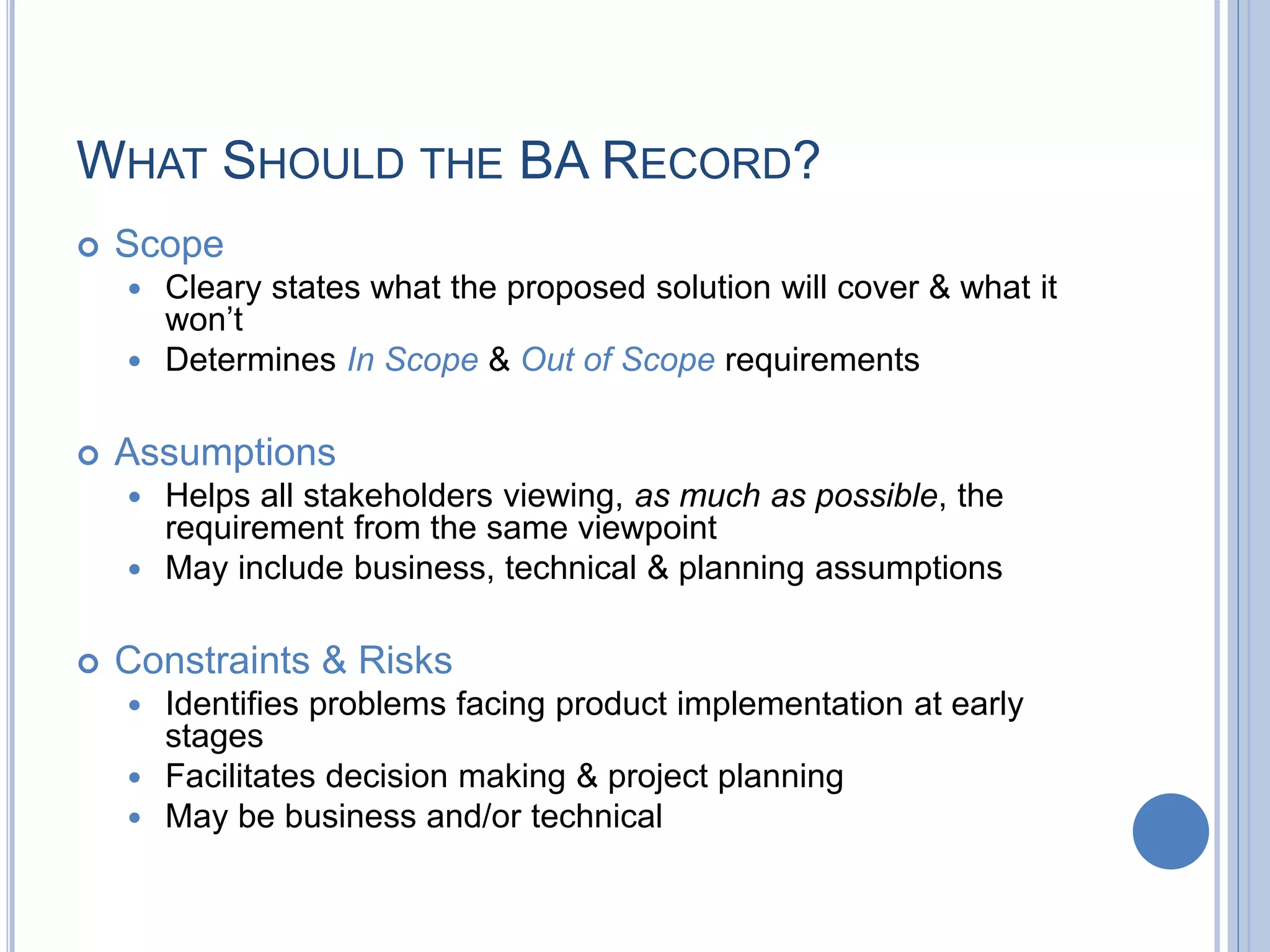

 Scope
 Cleary states what the proposed solution will cover & what it
won’t
 Determines In Scope & Out of Scope requirements
 Assumptions
 Helps all stakeholders viewing, as much as possible, the
requirement from the same viewpoint
 May include business, technical & planning assumptions
 Constraints & Risks
 Identifies problems facing product implementation at early
stages
 Facilitates decision making & project planning
 May be business and/or technical
WHAT SHOULD THE BA RECORD?

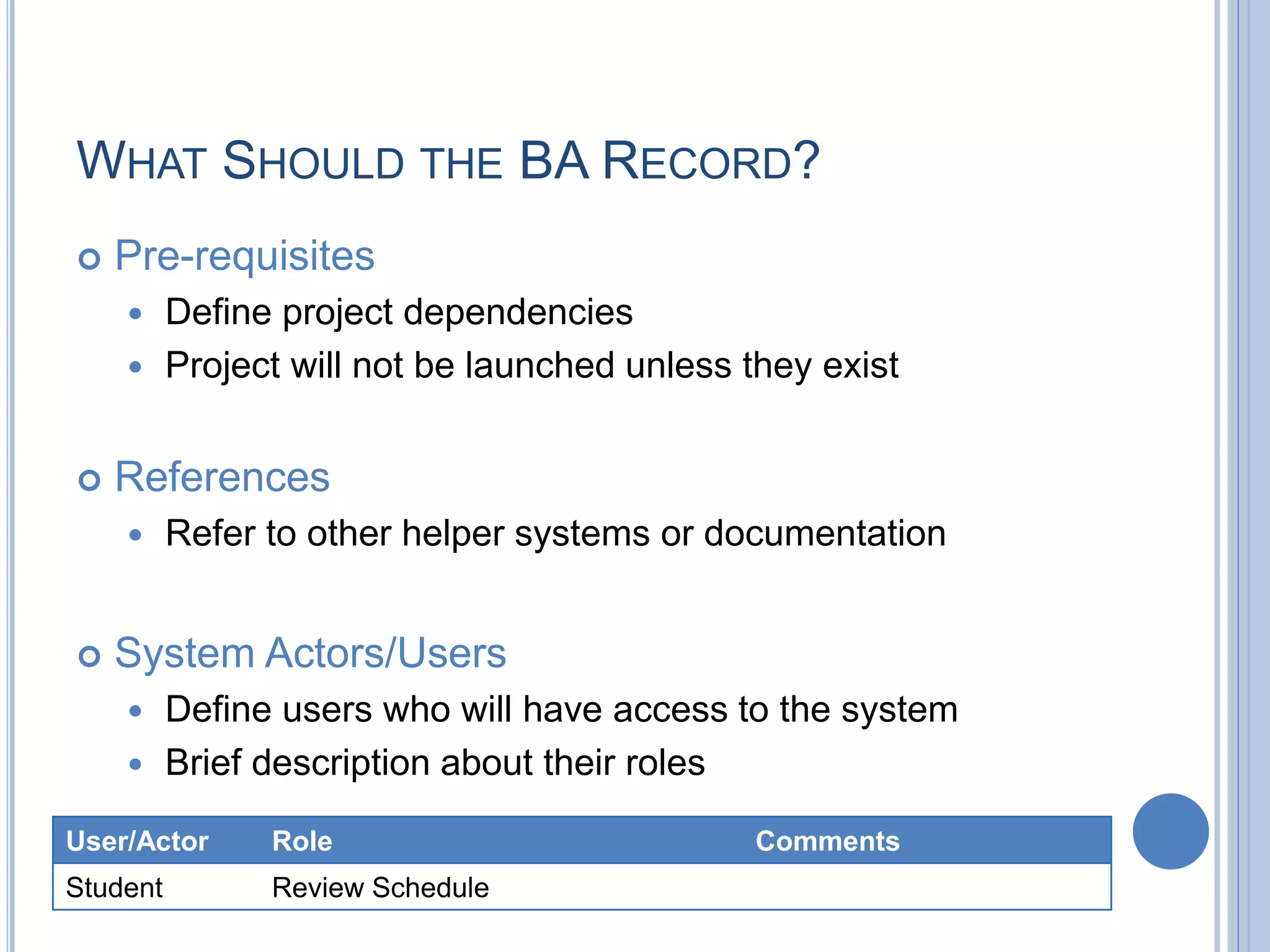

 Pre-requisites
 Define project dependencies
 Project will not be launched unless they exist
 References
 Refer to other helper systems or documentation
 System Actors/Users
 Define users who will have access to the system
 Brief description about their roles
User/Actor Role Comments
Student Review Schedule
WHAT SHOULD THE BA RECORD?
 Business Processes/Workflows
 Describe the steps of the business processes
 Use swim lanes presentation to illustrate the workflowExpenseReporting
AccountantManagerEmployee
Submit Expense
Report
Correct
Report
?
Issue Payment
Write Expense
Report
Sign
Yes
No
WHAT SHOULD THE BA RECORD?

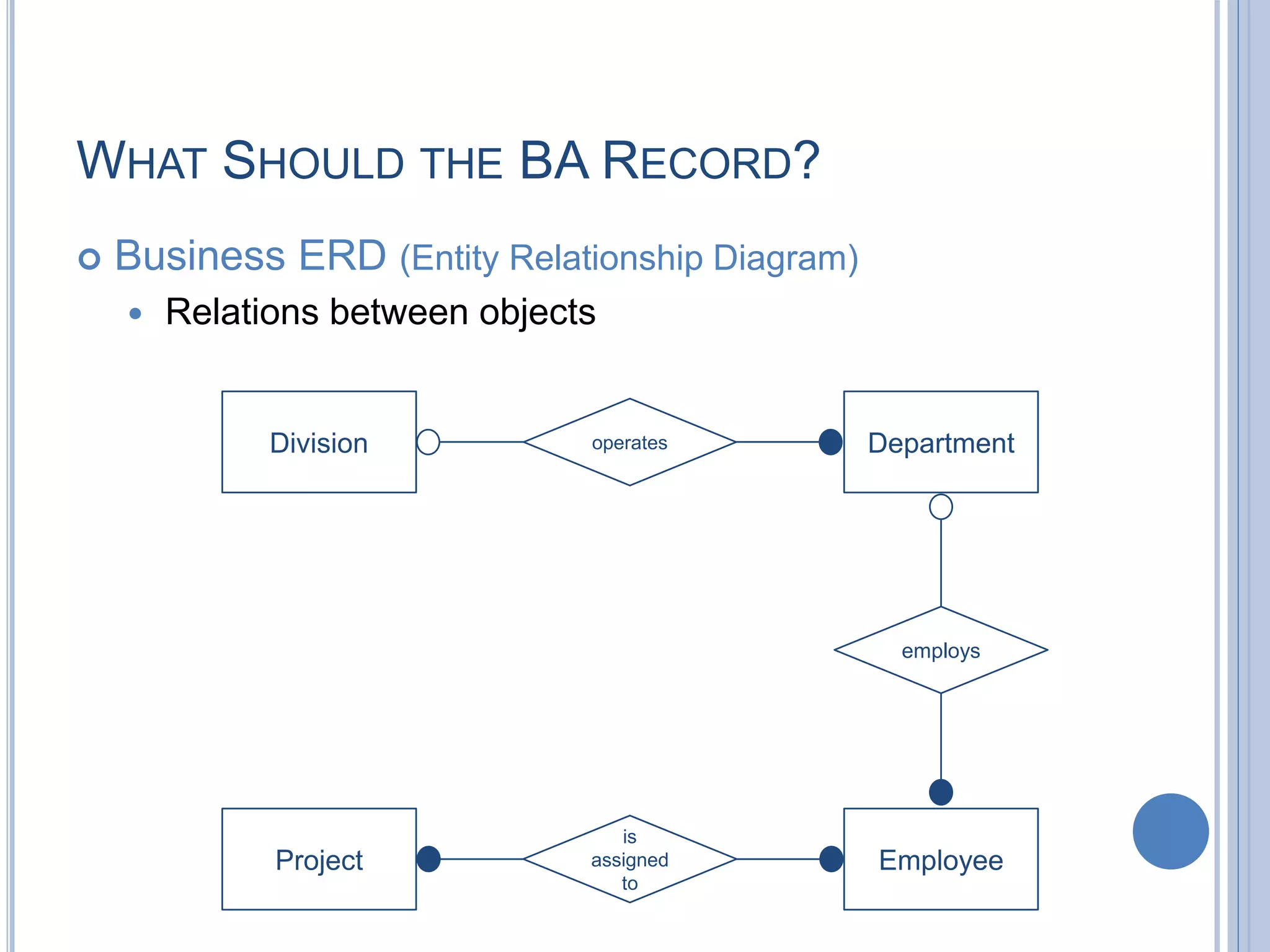

 Business ERD (Entity Relationship Diagram)
 Relations between objects
Division Department
EmployeeProject
is
assigned
to
operates
employs
WHAT SHOULD THE BA RECORD?

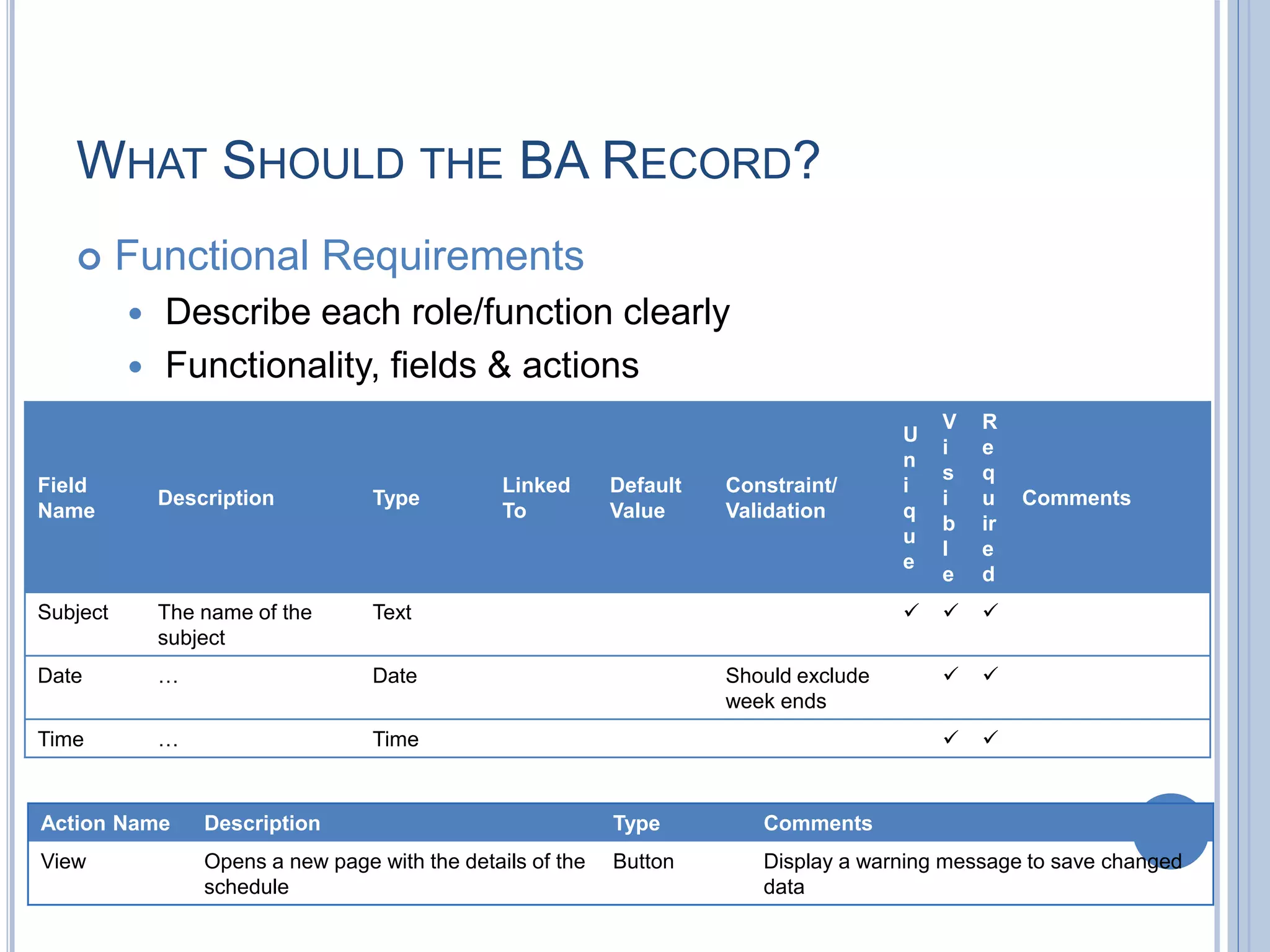

 Functional Requirements
 Describe each role/function clearly
 Functionality, fields & actions
Field
Name
Description Type
Linked
To
Default
Value
Constraint/
Validation
U
n
i
q
u
e
V
i
s
i
b
l
e
R
e
q
u
ir
e
d
Comments
Subject The name of the
subject
Text   
Date … Date Should exclude
week ends
 
Time … Time  
Action Name Description Type Comments
View Opens a new page with the details of the
schedule
Button Display a warning message to save changed
data
WHAT SHOULD THE BA RECORD?

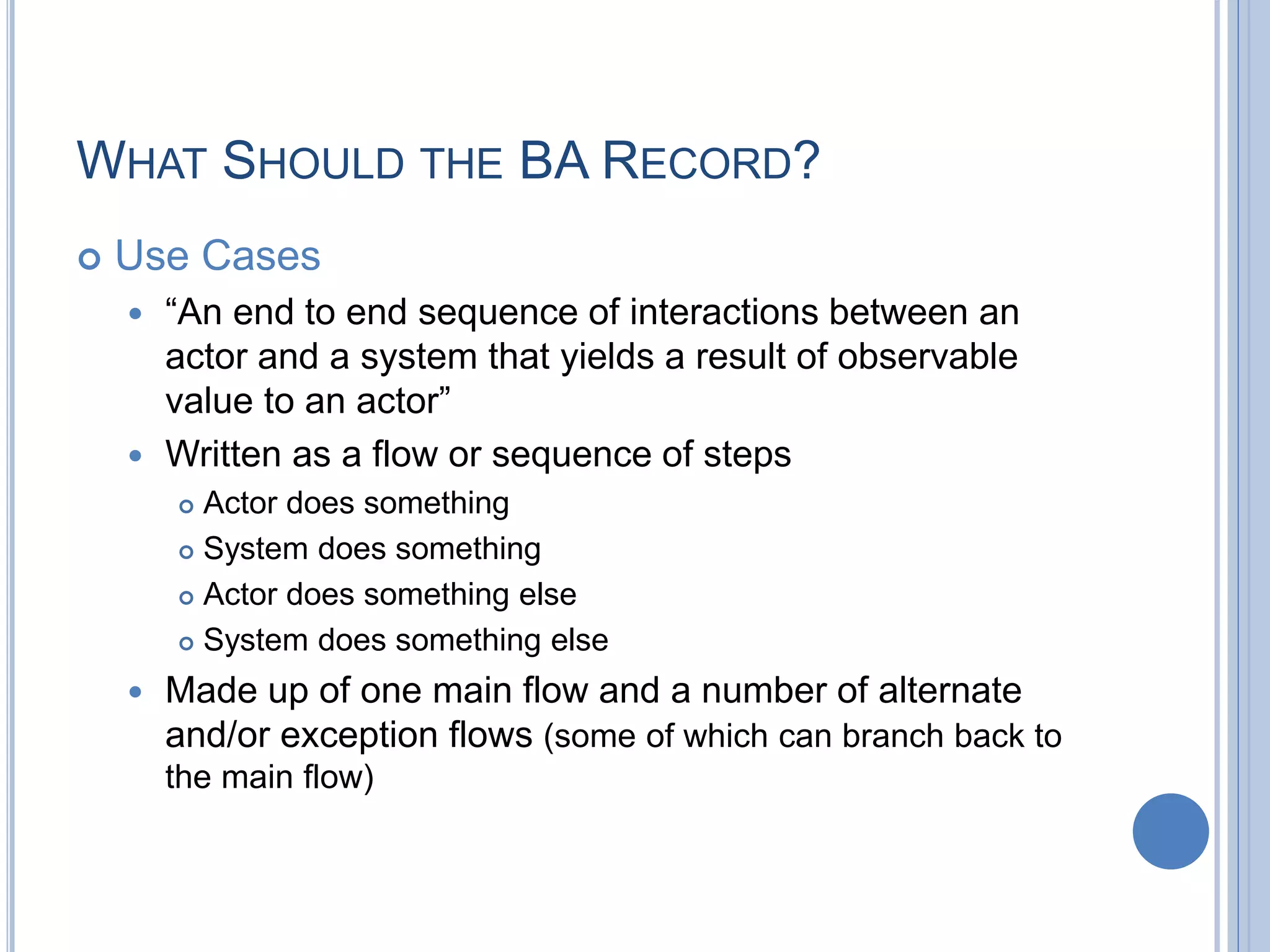

 Use Cases
 “An end to end sequence of interactions between an
actor and a system that yields a result of observable
value to an actor”
 Written as a flow or sequence of steps
 Actor does something
 System does something
 Actor does something else
 System does something else
 Made up of one main flow and a number of alternate
and/or exception flows (some of which can branch back to
the main flow)
WHAT SHOULD THE BA RECORD?
 Use Cases
Waiter
Client
Cashier
Chef
Order
Food
Serve
Food
Eat
Food
Pay for
Food
Order
Water
Cook
Food
Drink
Water
Pay for
Water
Serve
Water
Receive
order
Accept
payment
Pay
Facilitate
payment
Place
order
Confirm
order
<<extend>>
<<extend>>
<<extend>>
<<extend>>
{if water was
consumed}
{if water was
served}
{if water
was
ordered}
WHAT SHOULD THE BA RECORD?

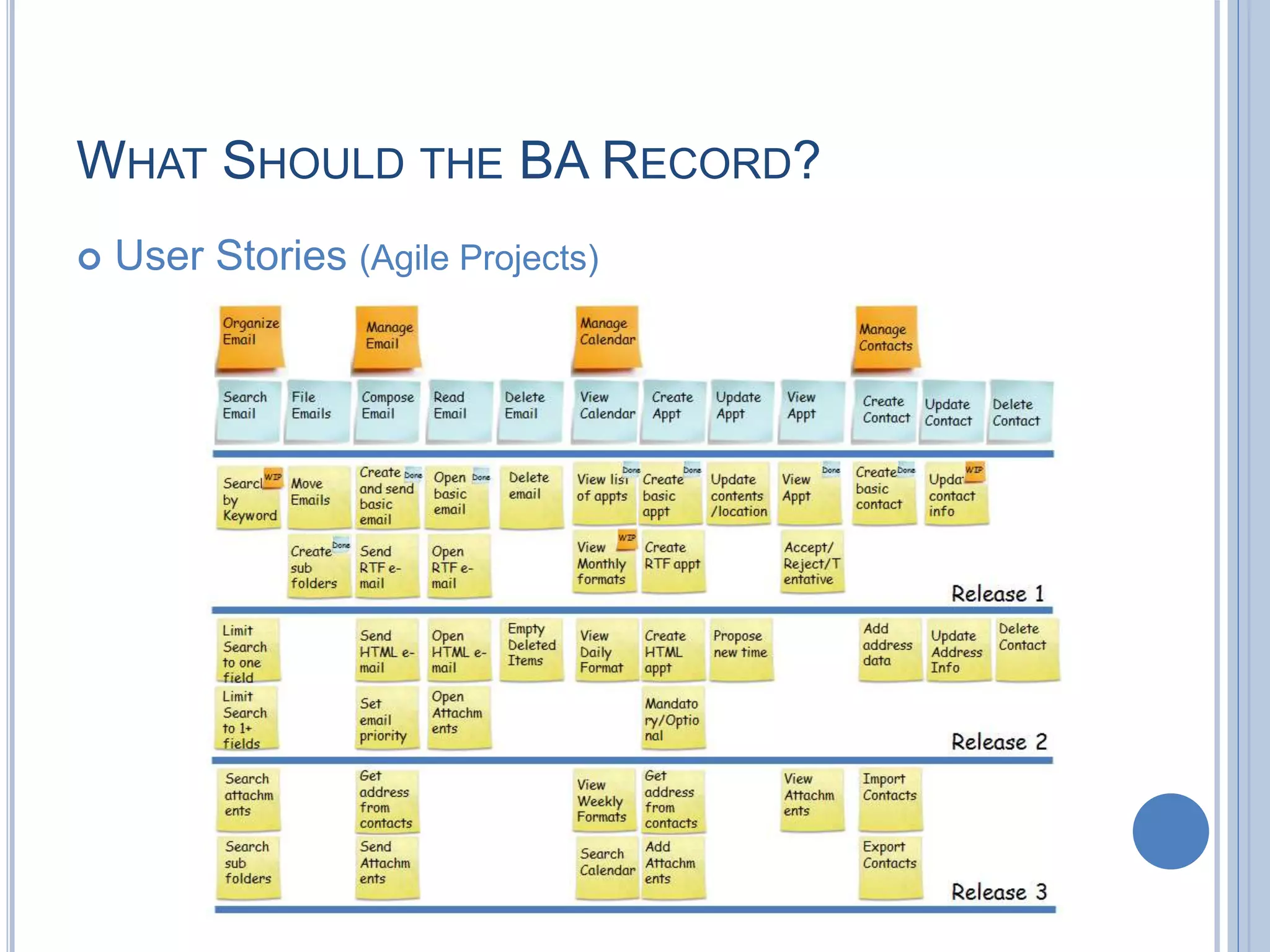

 User Stories (Agile Projects)
 A tool to support the iterative and incremental approach
 Provide a framework where the detail can be added as
it is needed, just enough and just in time
 Sentences described in everyday or business language
 Captures 'who', 'what' & 'why' of a requirement
 Limited in detail by what can be hand-written on a small
paper notecard
WHAT SHOULD THE BA RECORD?
 User Stories (Agile Projects)
WHAT SHOULD THE BA RECORD?
 Reporting Requirements
 What reports are needed
 Business need
 Report name, filters, output, header, footer
 GUI Requirements
 Describes the needed user graphical interface
 Look & feel
WHAT SHOULD THE BA RECORD?
 Non-functional Requirements
 Hardware & software requirements
 Performance, number of normal & concurrent users
 Page response time
 Usability, cultural aspects
 Availability, reliability, maintainability, extensibility, security…
 Open Issues/Pending Decision/Questions
 Help getting quick & precise answers to vague requirements
ID Question Owner Type Answer Status Priority Open Date Target Date
36
Will all students have the
same schedule
view? SH1 Business clarification Yes Closed High 6-Jun 10-Jun
MATCHING REQUIREMENTS WITH
USER EXPERIENCE
What Is UX?
Where Does UX Come?
Elements of UX Design

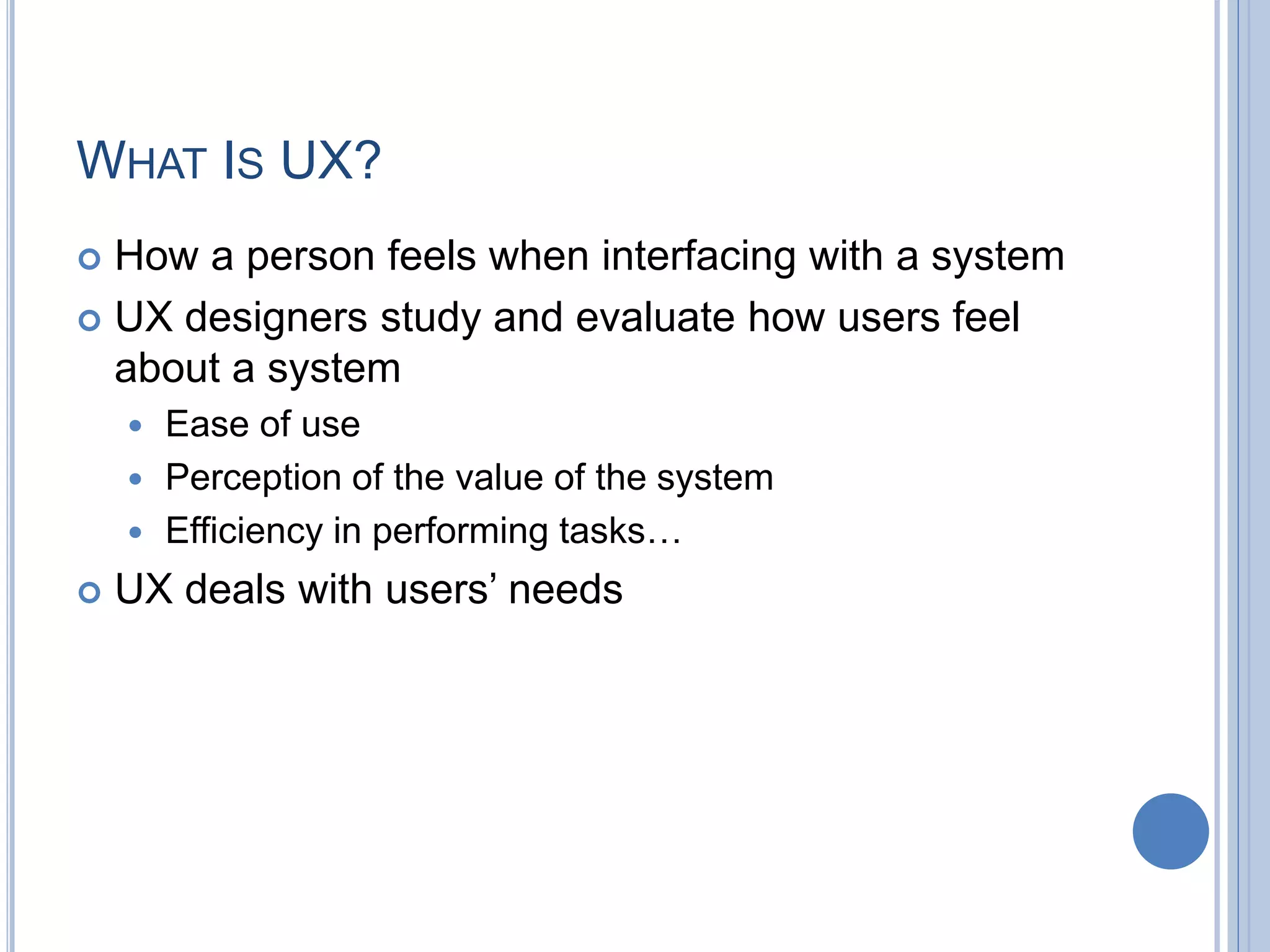

WHAT IS UX?
 How a person feels when interfacing with a system
 UX designers study and evaluate how users feel
about a system
 Ease of use
 Perception of the value of the system
 Efficiency in performing tasks…
 UX deals with users’ needs
WHERE DOES UX COME?
Business
System
Users
High Level
Detail
• Sponsor point of view
• Scope of the project
• Business objective
• User point of view
• User goals
• User inputs & outputs
• Functional
• Non-functional
ELEMENTS OF UX DESIGN

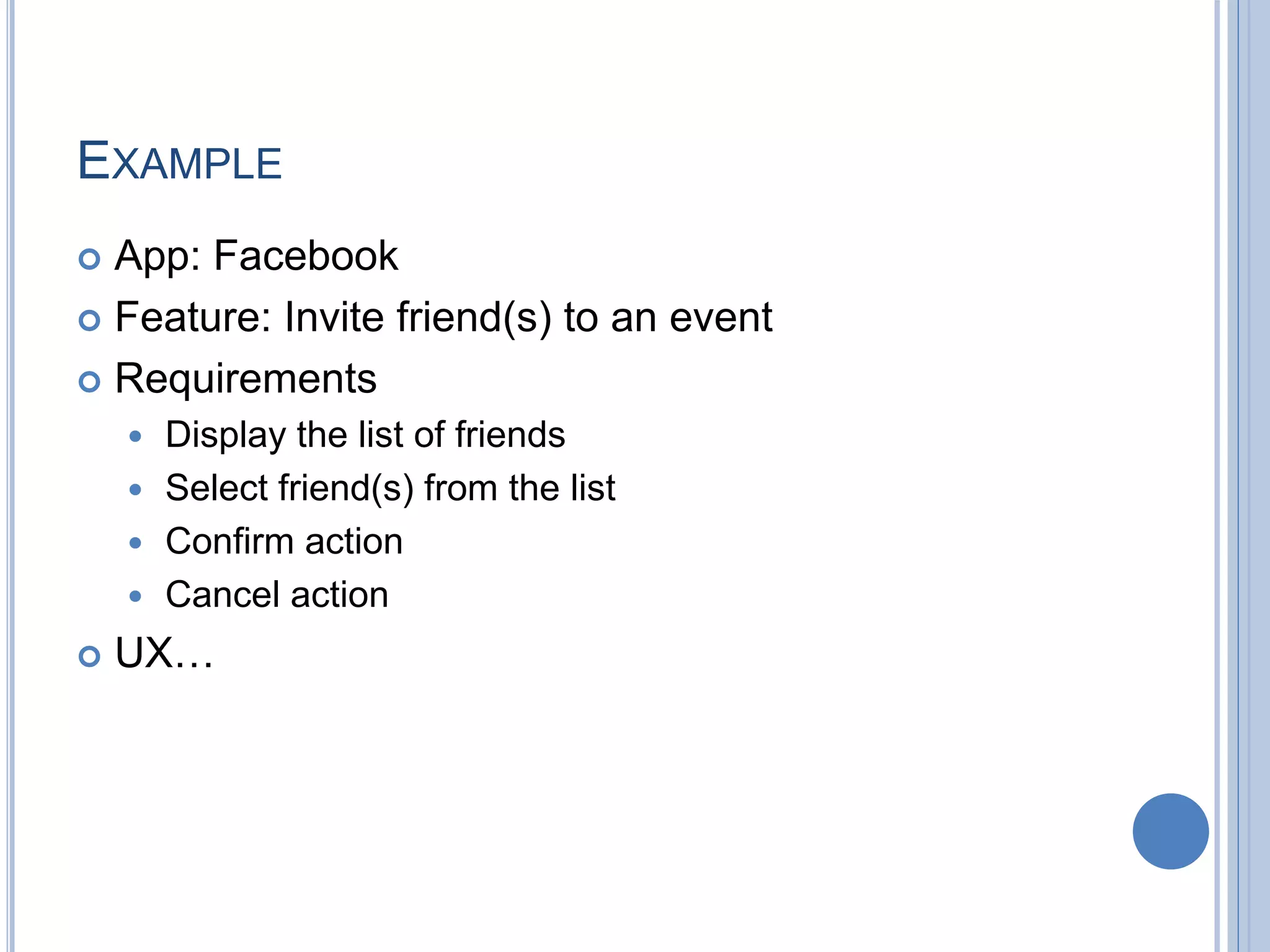

EXAMPLE
 App: Facebook
 Feature: Invite friend(s) to an event
 Requirements
 Display the list of friends
 Select friend(s) from the list
 Confirm action
 Cancel action
 UX…
EXAMPLE
Filter
Status info
Already invited
Selected Count
TOWARDS A BETTER OUTPUT
Guidelines
Tips
GUIDELINES
Users don't know what they want until you show it to them
GUIDELINES:1
 Focus & clarity
 Clearly state the objective & define the scope
 Clarify what the project does and does not cover
 A format for specifying requirements
 Use whichever method works for you
 Understanding is the most important outcome
 Not all formats of requirements documentation are equal
 Requirements document author
 Writing skills
 Balance understanding the project domain against
understanding the process of software development
GUIDELINES:2

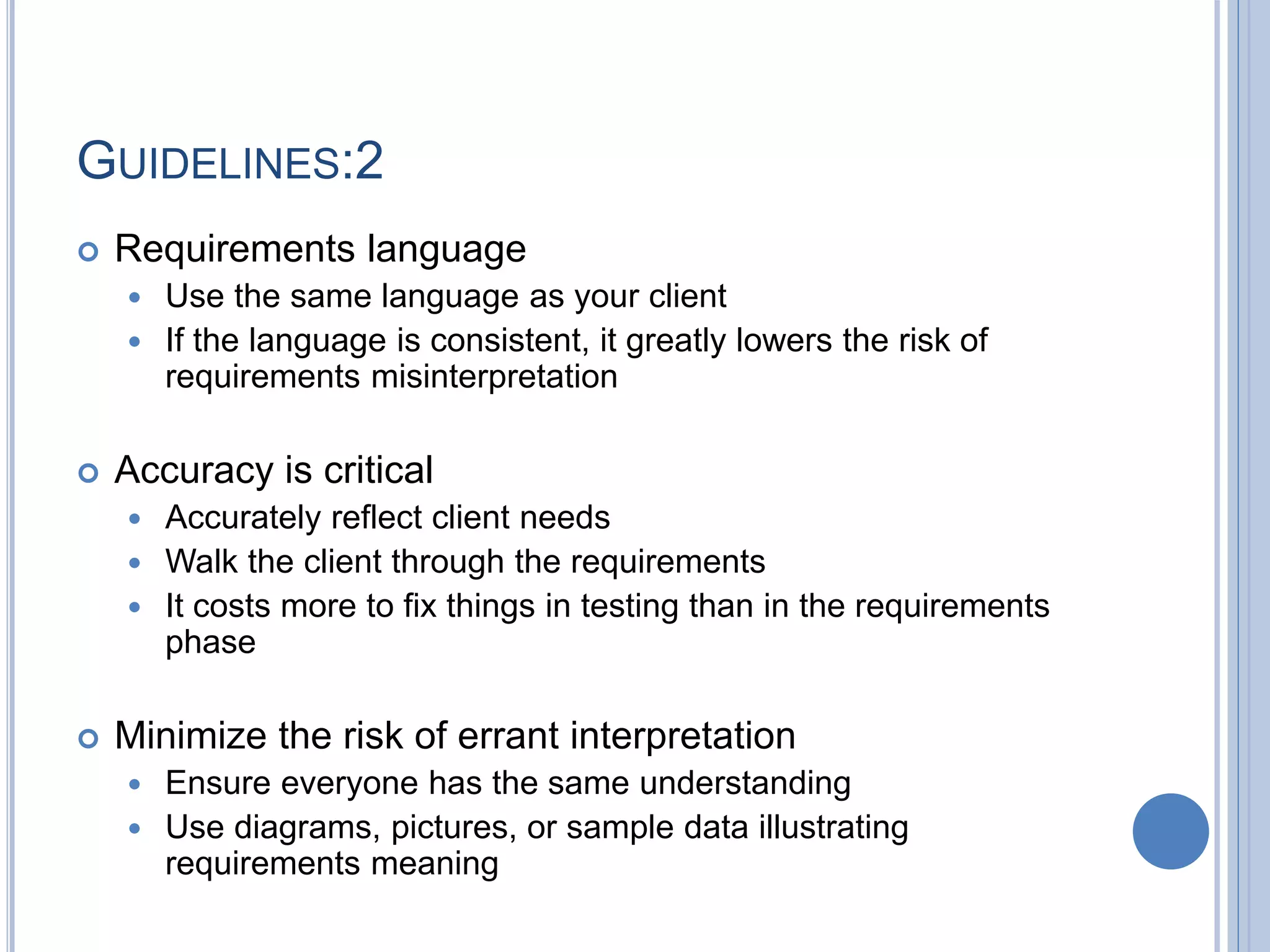

 Requirements language
 Use the same language as your client
 If the language is consistent, it greatly lowers the risk of
requirements misinterpretation
 Accuracy is critical
 Accurately reflect client needs
 Walk the client through the requirements
 It costs more to fix things in testing than in the requirements
phase
 Minimize the risk of errant interpretation
 Ensure everyone has the same understanding
 Use diagrams, pictures, or sample data illustrating
requirements meaning
TIPS
You never realize until you’ve been there!
TIPS:1
Build trust in your experience & knowledge
 Understand the business domain
 Act as a subject matter expert
 Be your client’s consultant
 Network and build relations
 Set correct expectation
 Give space for yourself
 Never promise before getting back to your team
 Educate your client
TIPS:2

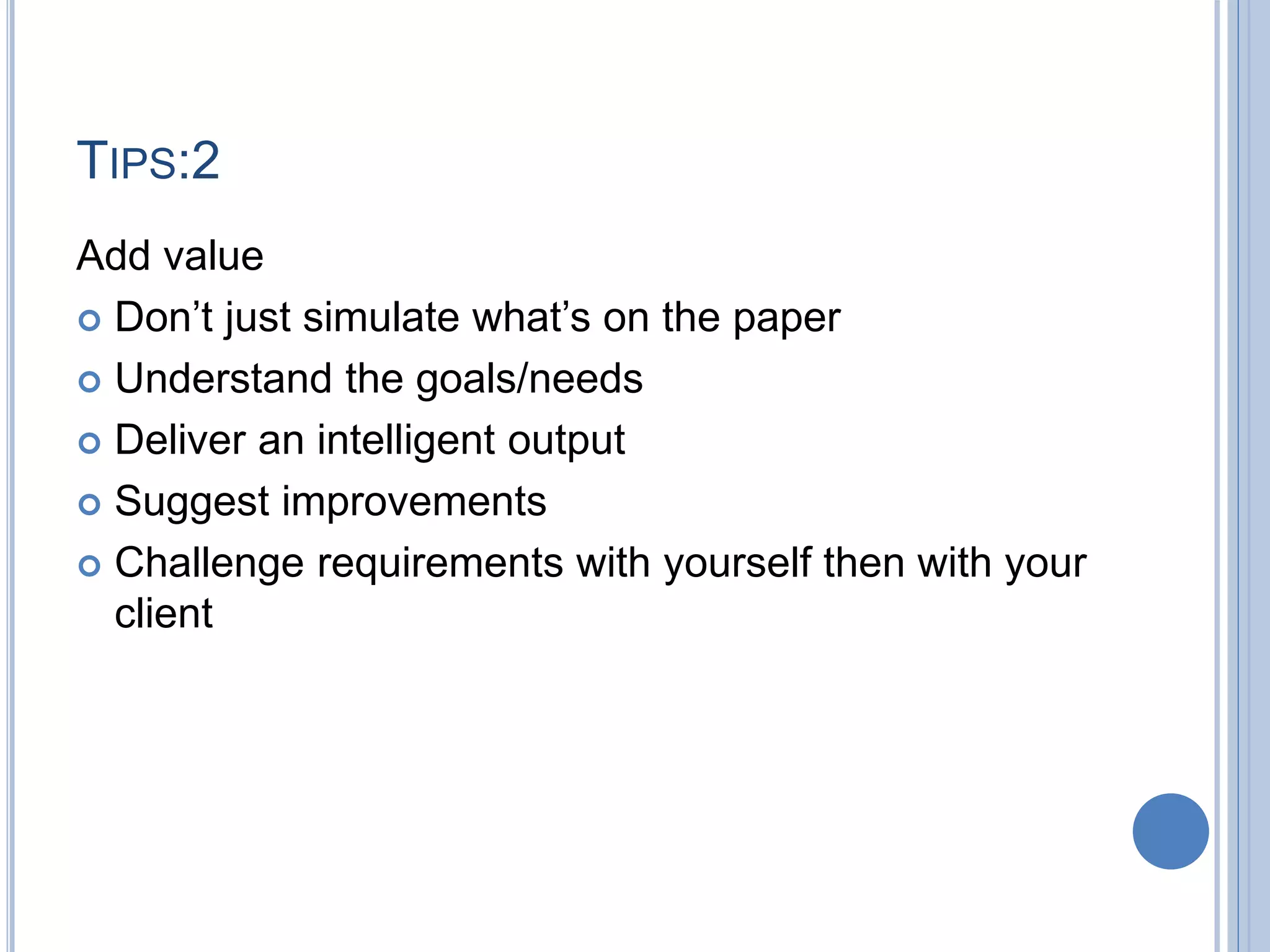

Add value
 Don’t just simulate what’s on the paper
 Understand the goals/needs
 Deliver an intelligent output
 Suggest improvements
 Challenge requirements with yourself then with your
client
TIPS:3

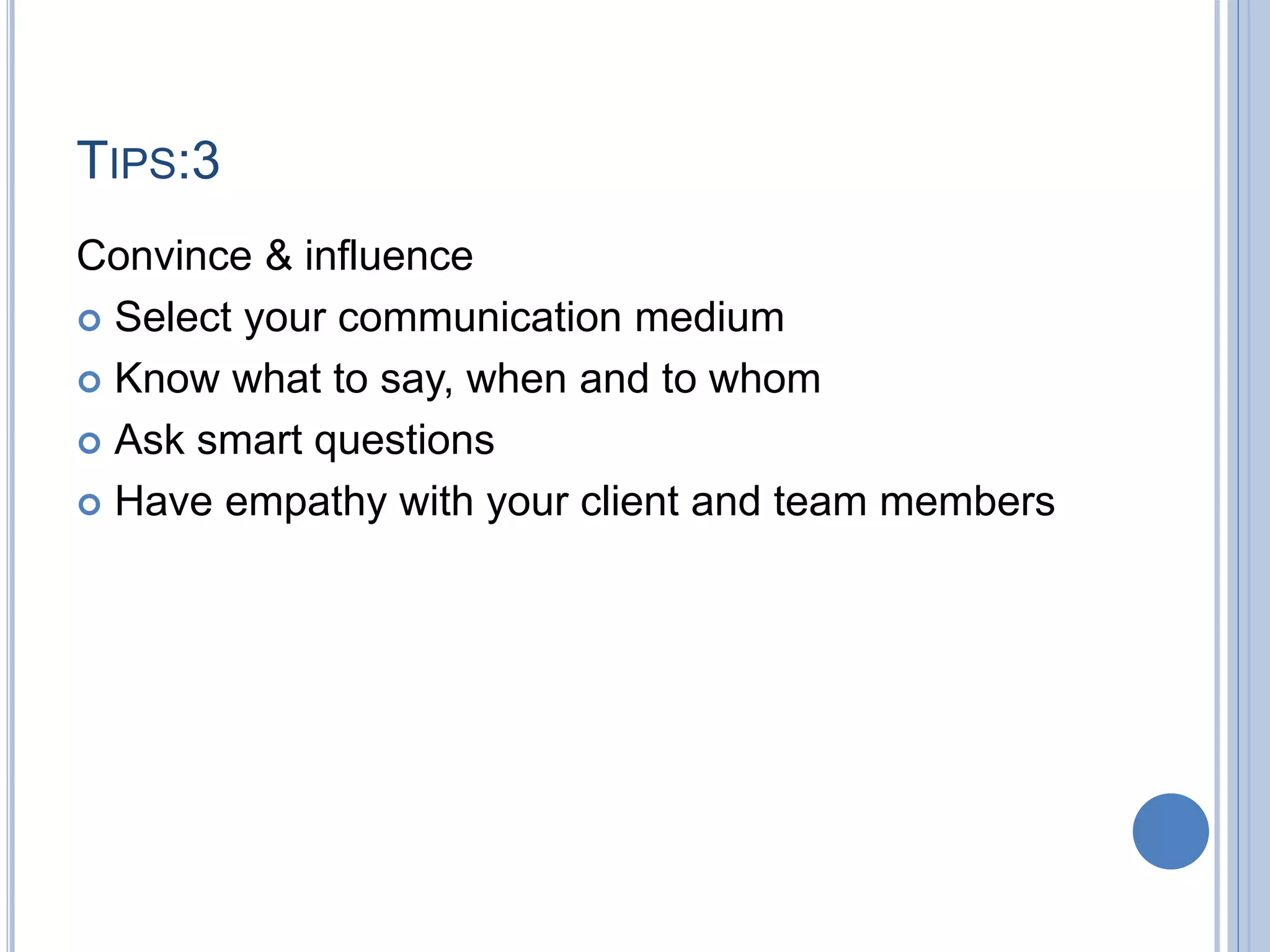

Convince & influence
 Select your communication medium
 Know what to say, when and to whom
 Ask smart questions
 Have empathy with your client and team members
TIPS:4
Protect the idea
 Do whatever it takes to deliver the idea
 Use visuals and illustrate with charts, WBS and
drawings
 Make it easy to trace and understand things
 Use examples and build scenarios
 Keep the business goal in mind and explain it to
your team
TIPS:5
Ask for assistance & be aware
 Refer to developers for advice, feasibility and
verification
 Keep the PM updated
 Understand the impact of additions on effort and
cost
 Know when to say No!
TIPS:6
Dig deeper
 Analyze, analyze, analyze
 Think about ways to group similar components
 Identify re-usable components and data
TIPS:7
Organize
 Use mind maps
 Track changes in your documents
 Track versions and brief about change history
 Document naming convention
TIPS:8

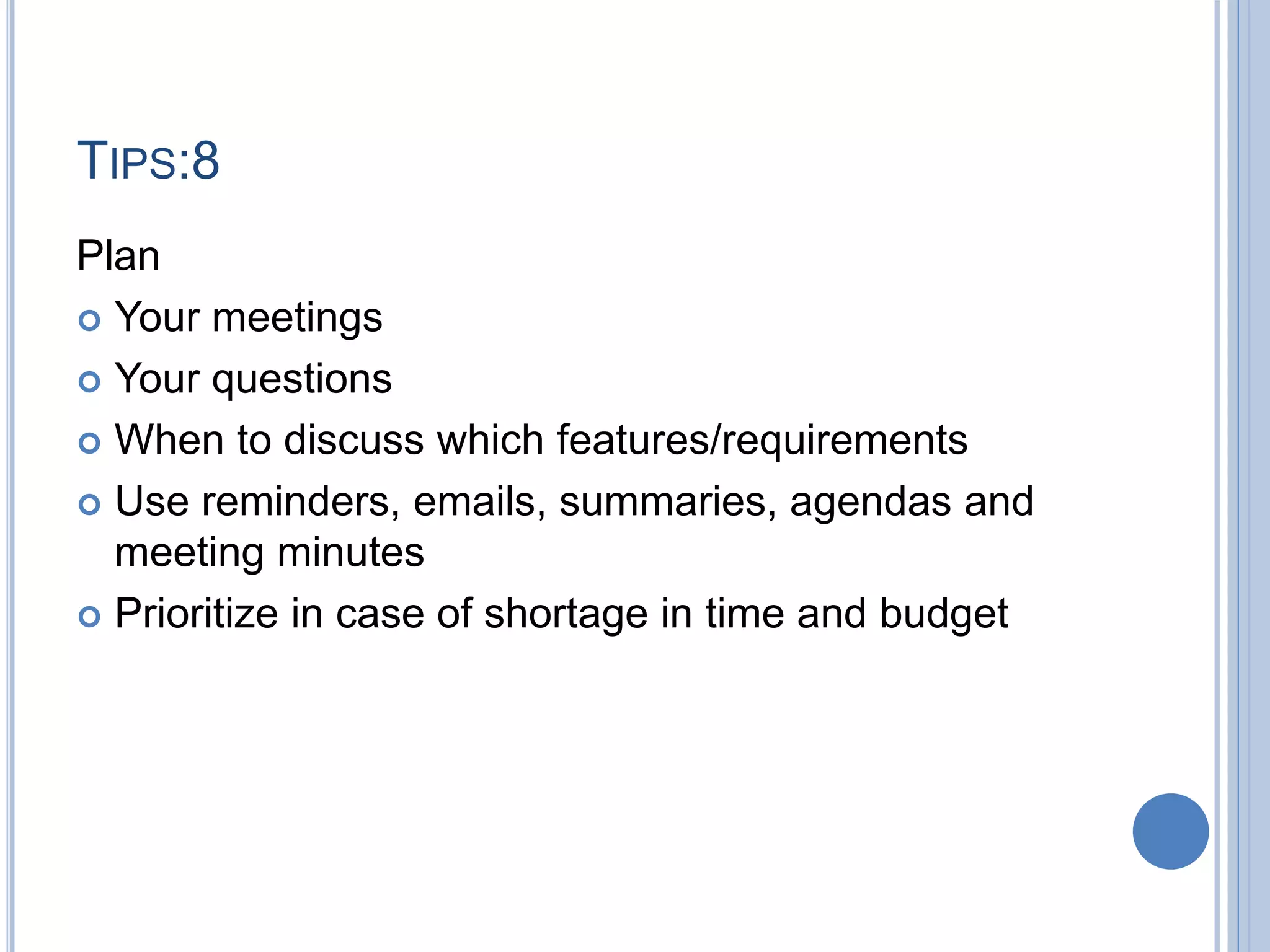

Plan
 Your meetings
 Your questions
 When to discuss which features/requirements
 Use reminders, emails, summaries, agendas and
meeting minutes
 Prioritize in case of shortage in time and budget
TIPS:9
Be productive
 Save your time and others’ time
 Eliminate paper and pen usage
 Document everything then select what to use
 Share online
 Minimize possibilities of re-work
 Take lead and be in control
CONCLUSION
Continuous effort to improve the quality of software
development activities
CONCLUSION
 There is no silver bullet, no one answer, no perfect
approach method or technique to requirements
gathering
 Developing a good requirements document is about
giving your project the best chance of success
 To do so, you must reduce the risk of common mistakes
that arise from a lack of communication or
understanding
 Keep this in mind as you gather your requirements that
project will have the best chance of success
THE WORKSHOP
No physician is really good before he has killed one or two
patients
~Hindu Proverb
ACTIVITIES
 Meeting with client
 Develop
 Requirements document
 Presentation for the top management approval
 Review deliverables together
 Evaluation
 Team will evaluate each other
 Mentor’s evaluation
WHAT WE WILL EVALUATE
 Requirements
 Taking care of all
requirements
 Clearness of
requirements in head
 Ability to answer
questions
 Maintaining scope
 Using examples
 Adding value
 Challenging input
 Asking meaningful
questions
 Management
 On time delivery
 Decision making
 Signoff
 Overall
 Being productive
 Maintaining
professional image
 Ability to convince &
influence
LET’S GO!
LET’S KEEP IN TOUCH
 Twitter: @menameissa
 Blog: A Project Manager’s Diary
 Slide Share presentation:
http://www.slideshare.net/menameissa/business-
requirements-gathering-and-analysis
THANK YOU
REFERENCES
The credit goes to…

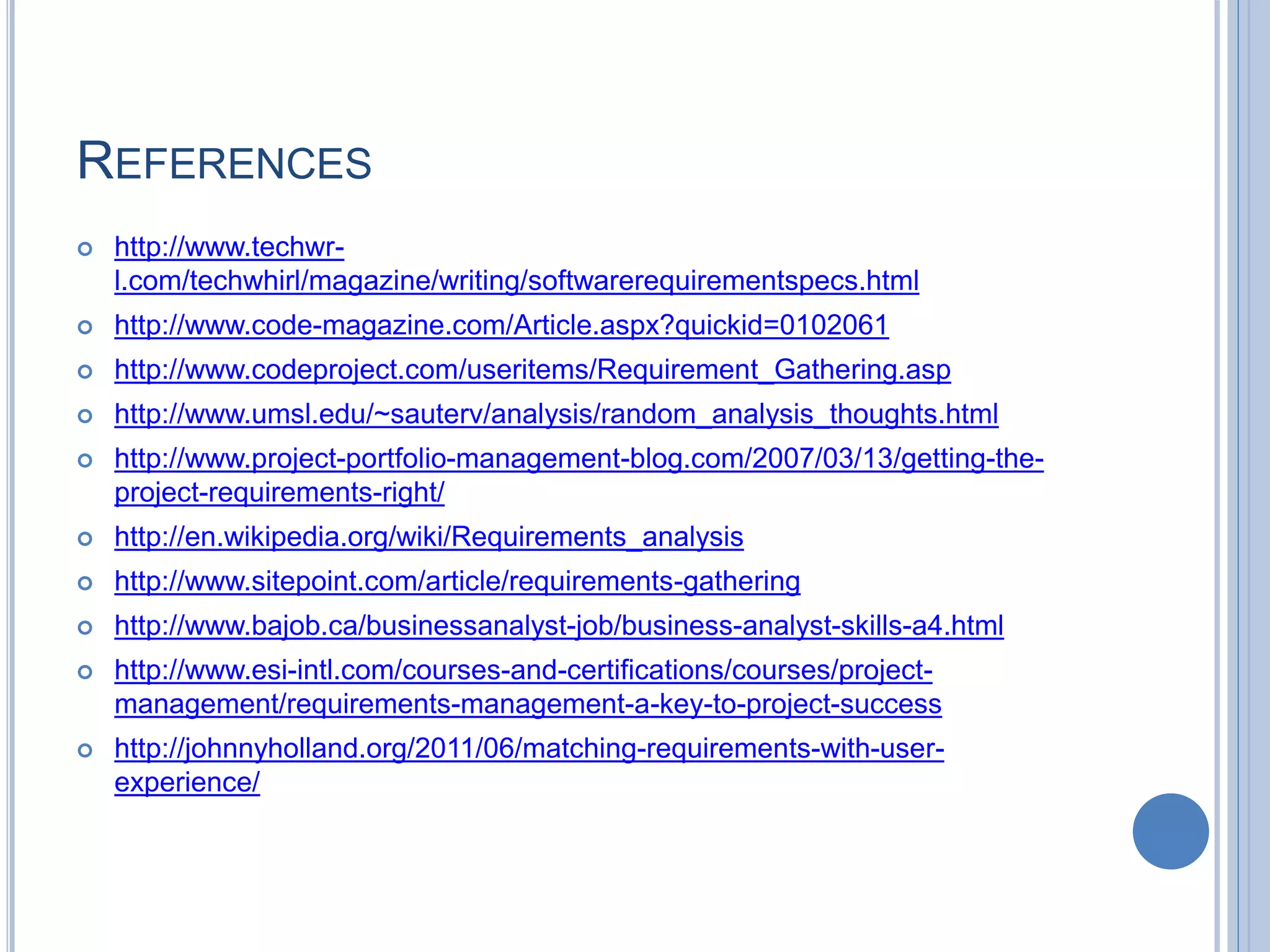

REFERENCES
 http://www.techwr-
l.com/techwhirl/magazine/writing/softwarerequirementspecs.html
 http://www.code-magazine.com/Article.aspx?quickid=0102061
 http://www.codeproject.com/useritems/Requirement_Gathering.asp
 http://www.umsl.edu/~sauterv/analysis/random_analysis_thoughts.html
 http://www.project-portfolio-management-blog.com/2007/03/13/getting-the-
project-requirements-right/
 http://en.wikipedia.org/wiki/Requirements_analysis
 http://www.sitepoint.com/article/requirements-gathering
 http://www.bajob.ca/businessanalyst-job/business-analyst-skills-a4.html
 http://www.esi-intl.com/courses-and-certifications/courses/project-
management/requirements-management-a-key-to-project-success
 http://johnnyholland.org/2011/06/matching-requirements-with-user-
experience/
REFERENCES
 http://smallbusiness.chron.com/functional-requirements-vs-business-requirements-
65938.html
 http://www.advstr.com/web/resources/downloads/Defining_Requirements.pdf
 http://www.accompa.com/kb/answer.html?answer_id=170
 http://rmblog.accompa.com/2012/06/features-vs-use-cases-vs-requirements/
 http://www.businessanalystsolutions.com/what_is_a_business_analyst.html
 http://www.villanovau.com/resources/business-analysis/business-analyst-job-
description/#.VSqagRCUftI
 http://en.wikipedia.org/wiki/Verification_and_tion
 http://www.ppmstudio.com/Solutions_ApplicationLifecycleManagement.aspx
 http://www.iai.uni-
bonn.de/III/lehre/vorlesungen/SWT/RE05/slides/08_Requirements%20Manageme
nt.pdf
 http://www.projectsmart.co.uk/smart-goals.php
 http://www.wikihow.com/Write-a-Requirements-Document
 http://www.bridging-the-gap.com/what-requirements-specifications-do-business-
analysts-create/

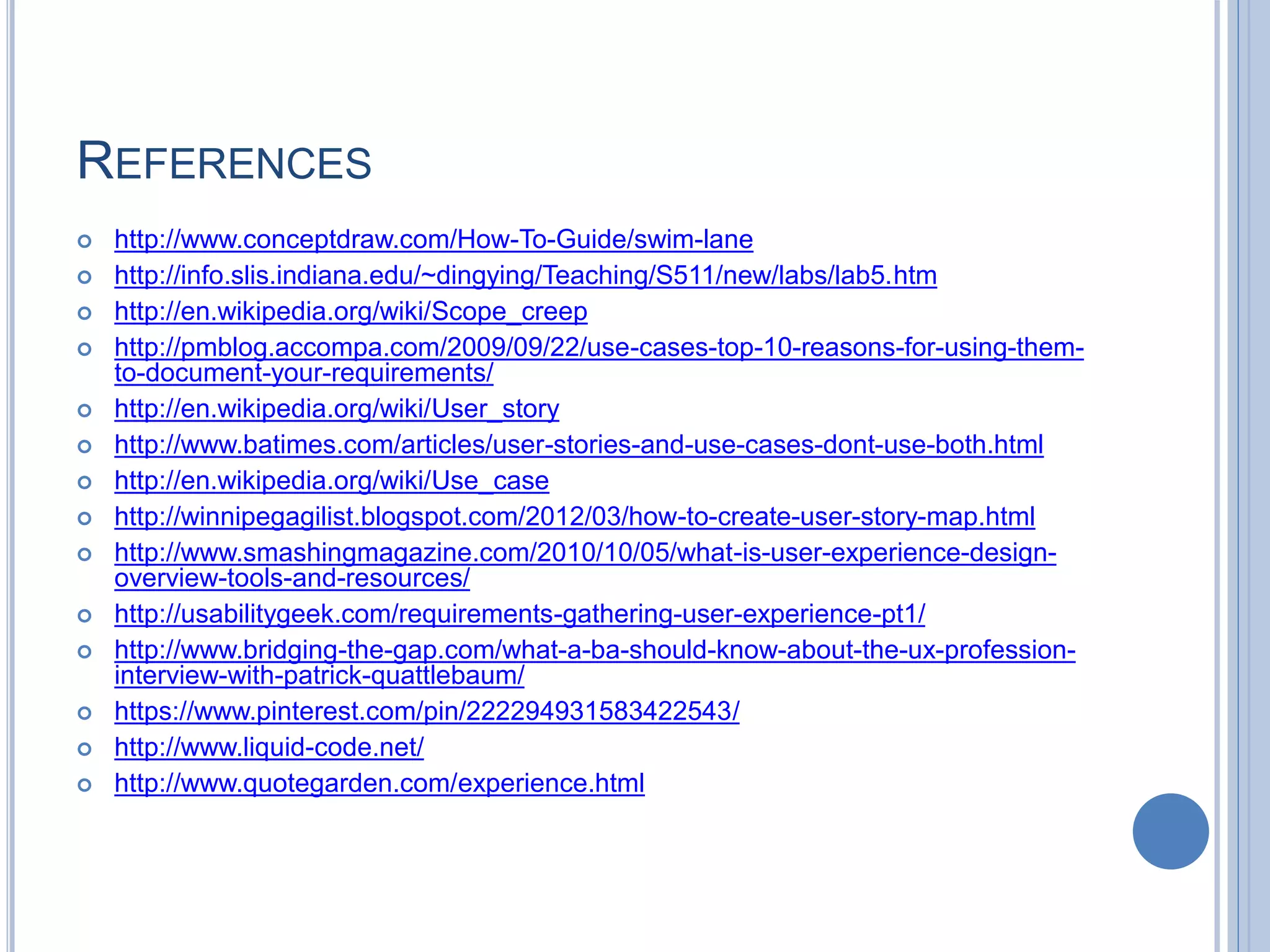

REFERENCES
 http://www.conceptdraw.com/How-To-Guide/swim-lane
 http://info.slis.indiana.edu/~dingying/Teaching/S511/new/labs/lab5.htm
 http://en.wikipedia.org/wiki/Scope_creep
 http://pmblog.accompa.com/2009/09/22/use-cases-top-10-reasons-for-using-them-
to-document-your-requirements/
 http://en.wikipedia.org/wiki/User_story
 http://www.batimes.com/articles/user-stories-and-use-cases-dont-use-both.html
 http://en.wikipedia.org/wiki/Use_case
 http://winnipegagilist.blogspot.com/2012/03/how-to-create-user-story-map.html
 http://www.smashingmagazine.com/2010/10/05/what-is-user-experience-design-
overview-tools-and-resources/
 http://usabilitygeek.com/requirements-gathering-user-experience-pt1/
 http://www.bridging-the-gap.com/what-a-ba-should-know-about-the-ux-profession-
interview-with-patrick-quattlebaum/
 https://www.pinterest.com/pin/222294931583422543/
 http://www.liquid-code.net/
 http://www.quotegarden.com/experience.html

Business requirements gathering and analysis

  • 1.
    BUSINESS REQUIREMENTS By: MenaMostafa Apr-2015 Gathering & Analysis Workshop A key to project success
  • 2.
    WHO AM I? MenaMostafa  Instructor, Coach & Advisor  15 years experience (software development field)  Project Manager, Business Analyst & Developer  Worked in the enterprises world (ASSET, ITWorx, etisalat…)  Managed over 150 projects (simple websites, portals, ERP, eCommerce, games…)  Requirements gathering & management SME in ITWorx  Led teams (co-located, remote, vendors)  Joined the entrepreneurship & the world of startups
  • 3.
    WHO ARE YOU? Introduce yourself  What would you like to know?
  • 4.
    WHY WE AREHERE?  Intentions  Understand what business requirements and analysis are  Understand how a full-spectrum of requirements fit together  Pick up some tips that might be useful on your projects  Values  Coaching session  More practical than theoretical  Context  Our time is short and our topic is large
  • 5.
    SCHEDULE The Theory Break (30mins) The Workshop Break (30 mins) Review & Evaluation
  • 6.
     Switch off/silentyour mobile phones  Participate  Ask questions  Share your experience  Make mistakes & learn from them  Request a break when you need to  Respect break times  Have fun! THE DEAL
  • 7.
    TOPICS  Introduction  Commonissues & challenges  The Business Analyst  How to do the job?  Requirements gathering techniques  How to document requirements?  Matching requirements with user experience  Towards a better output  The workshop
  • 8.
    INTRODUCTION Why Requirements Gathering& Analysis? What Is Requirements Gathering? Types of Software Projects Requirements & Features Types of Requirements
  • 9.
    WHY REQUIREMENTS GATHERING& ANALYSIS? This common sense seems to disappear! “Measure twice, cut once” “Look before you leap”  What do these sayings have in common? They're about Thinking before Acting  Why? Because it Saves time, money and effort It's plain common sense Yet, when it comes to software development…
  • 10.
    WHAT IS REQUIREMENTSGATHERING?  A Process of Collecting the user needs to Solve a problem or issues and Achieve an objective  An important Phase in a project life cycle If the Requirements Gathering is not done properly All below phases get incomplete No matter how good the Design is Requirements are the foundation of any Project If you don’t know where you’re going, any road will take you there!
  • 11.
    TYPES OF SOFTWAREPROJECTS  New Development: services & products  Implementation: customization on existing software (service or product)  Research: proof of concept for new ideas  Bug Fixing & Modifications: on existing software (service or product)  Maintenance & Support: on existing software (service or product)
  • 12.
    WHAT IS AREQUIREMENT?  A requirement is a capability that a product must possess to satisfy a customer need or objective  A key component of any business project  They help a project team define  Goals  Scope of the work  They provide objective ways to measure the project's success
  • 13.
    BUSINESS REQUIREMENT  Aseries of needs that must be fulfilled to achieve a high-level objective  Clear business requirements help ensure that the end result of a project fulfills the stakeholders' needs
  • 14.
    FUNCTIONAL REQUIREMENT  Adetailed breakdown that explains how the outcome of a project will operate to meet the specified business requirements  Include a list of the steps that each user will take in the new system  The functional requirements for a project are defined and developed after the project's business requirements have been established
  • 15.
    BUSINESS REQUIREMENT VS.FUNCTIONAL REQUIREMENT Upgrade the manual payroll process by switching to an automated payroll process  Business requirements “Implement a computerized system that reduces errors and increases efficiency by calculating employees' wages, withholding required deductions and paying the employee the amount she is owed.”  Functional requirements  How many employees the system must accommodate  Are they hourly, salaried or both  What a pay period is  What states' tax
  • 16.
    NON-FUNCTIONAL REQUIREMENTS  Whatan organization needs to do to support the project's outcome during and after implementation  Examples:  Hardware  Software  Performance  Number of normal and concurrent users  Page response time  Usability  Cultural aspects  Availability  Reliability  Maintainability  Extensibility  Security…
  • 17.
    WHAT IS AFEATURE?  A set of logically related requirements that allows the user to satisfy an objective  A feature tends to be a higher-level objective than a requirement  A requirement tends to be granular, and is written with the implementation in mind  A feature is something you’ll print on a detailed datasheet of your product
  • 18.
    FEATURE VS. REQUIREMENT Feature  Online shopping cart  Requirements  User shall be able to add books to online shopping cart  User shall be able to remove books from online shopping cart  User shall be able to view books in the online shopping cart at any time  User shall be able to start his checkout from the shopping cart
  • 19.
    I’m trying towrite a DOS bat file that runs an Access macro to import a CSV output file from my COBOL program. Any help would be appreciated!
  • 20.
    TYPES OF REQUIREMENTS Conscious Requirements Stakeholder is aware of  Unconscious Requirements Stakeholder knows the requirement so well that he thinks that it's not worth mentioning  Undreamed Requirements Stakeholders does not ask for, either because he thinks they are not possible or because they are new ideas that have occurred to them
  • 21.
    COMMON ISSUES &CHALLENGES Why Do Projects Fail? Requirements Gathering Challenges Requirements Volatility Causes What Causes Changes to Requirements? Scope Creep
  • 22.
    The sooner youbegin coding the later you finish
  • 23.
    WHY DO PROJECTSFAIL? A Standish group research report says that:  31% of all projects are cancelled before they ever get completed  53% of projects cost almost twice their original estimates
  • 24.
    REQUIREMENTS GATHERING CHALLENGES A useris somebody who tells you what they want the day you give them what they asked for
  • 25.
    STAKEHOLDERS ISSUES  Usersdon't understand what they want  All requirements are critical, no priority is defined  Scope and Vision not clearly defined  Users won't commit to a set of written requirements  Users change requirements after the cost and schedule have been fixed  Communication with users is slow  Users often do not participate in reviews  Users are technically unsophisticated  Users don't understand the development process  Users don't know about present technology
  • 26.
    ENGINEER/DEVELOPER ISSUES  Technicalpersonnel and end users may have different vocabularies  Consequently, they may wrongly believe they are in perfect agreement until the finished product is supplied  Engineers and developers may try to make the requirements fit an existing system or model, rather than develop a system specific to the needs of the client  Analysis may be often carried out by engineers or programmers, rather than personnel with the people skills and the domain knowledge to understand a client's needs properly
  • 27.
     What ifthese challenges were not beaten? The final product will not be Delivered to the customer Successfully in Time  Why? Because the impact of the above points is huge in the product’s life cycle
  • 28.
    “What if usersdeveloped their own applications?!”
  • 29.
    What is noton paper has not been said
  • 30.
    REQUIREMENTS VOLATILITY CAUSES Internal Factors  Not capturing requirements from all relevant stakeholders  Not using right requirement capturing technique depending on the context  Not capturing all relevant details  Not having measures such as check-list to ensure completeness of requirements captured  Not having measures to ensure clarity  External Factors  Market driven
  • 31.
    WHAT CAUSES CHANGESTO REQUIREMENTS?  Requirements errors, conflicts and inconsistencies during analysis  Evolving customer/end-user knowledge of the system  Technical, schedule or cost problems  Changing customer priorities  Changing business environment  Emergence of new competitors, staff changes, etc.  New laws, regulations  Environmental changes  Organizational changes  Changes in structure and processes  New technology (technology push)
  • 32.
    SCOPE CREEP  Refersto uncontrolled changes or continuous growth in a project's scope  This can occur when the scope of a project is not properly defined, documented, or controlled  It is generally considered harmful
  • 33.
    WHO IS THEBUSINESS ANALYST? The Analyst Job Responsibilities Business Analyst Qualifications
  • 34.
    THE ANALYST JOB Demonstrate the ability and inclination to tolerate  chaos  ambiguity  and lack of knowledge  and to function effectively in spite of them
  • 35.
    RESPONSIBILITIES Help businesses implementtechnology solutions in a cost-effective way by:  Understanding business change needs  Assessing the business impact of those changes  Capturing, analyzing and documenting requirements  Supporting the communication and delivery of requirements with relevant stakeholders
  • 36.
    I know thatyou believe that you understand what you think I said but I am not sure you realize that what you heard is not what I meant
  • 37.
  • 38.
    BUSINESS ANALYST QUALIFICATIONS Technical Analytical Business Management Communication •Engineering systems concepts and principles • Technical computer knowledge • Complex modeling techniques • Technical writing
  • 39.
    BUSINESS ANALYST QUALIFICATIONS Technical Analytical Business Management Communication •Details oriented • Planning, documentation, analysis and business requirements management techniques • Evaluation of profitability/risk • Testing, verification and validation techniques
  • 40.
    BUSINESS ANALYST QUALIFICATIONS Technical Analytical Business Management Communication •Ability to have a business- oriented vision • Improvement of business and engineering processes • Strategic planning • Business writing
  • 41.
    BUSINESS ANALYST QUALIFICATIONS Technical Analytical Business Management Communication •Fundamentals of project management • Management of customer relationships • Time management & personal organization skills • Decision-making
  • 42.
    BUSINESS ANALYST QUALIFICATIONS Technical Analytical Business Management Communication •Communication of technical information to a non-technical audience • Communication of business information to a technical audience • Negotiation • Tact
  • 43.
    HOW TO DOTHE JOB? Software Development Lifecycle (SDLC) Requirements Management Process Requirements Gathering Activities Change Management Requirements Traceability Signoff
  • 44.
  • 45.
  • 46.
    REQUIREMENTS GATHERING ACTIVITIES ElicitingRequirements Communicating with users to determine their requirements Analyzing Requirements Determining whether the stated requirements are unclear, incomplete, ambiguous, or contradictory and then resolving these issues Recording Requirements Requirements may be documented in various forms  Natural-language documents  Use cases  User stories  Process specifications Validating Requirements Checking that a product, service, or system meets requirements and that it fulfills its intended purpose
  • 47.
    A user willtell you anything you ask about, but nothing more
  • 48.
    CHANGE MANAGEMENT  Theprocess of managing the changes to requirements  Hard problem because of continuous changes during development process  The principal concerns are  Managing the relationships between requirements  Managing priorities between requirements  Managing changes to agreed requirements  Managing the dependencies between different documents  requirements document  other documents produced in the systems engineering process
  • 49.
    REQUIREMENTS TRACEABILITY  Requirementscannot be managed effectively without traceability  Traceable means knowing about  Who suggested the requirement  Why exists the requirement  What requirements are related to it  How relates that requirement to other information such as:  Mockups  System design  Implementations  User documentation
  • 50.
    SIGNOFF  Final &most important step in requirements gathering process  Requirements should be freezed  Later request for changes should be treated separately  Technical opinion should be involved  Review with customer before signoff
  • 51.
  • 52.
    REQUIREMENTS GATHERING TECHNIQUES 4 out of 5 software development projects go over time, over budget or don’t deliver expected results  Poor requirements account for 71% of software project failures  It pays to put in the effort upfront to minimize the risk of failure  The question is, how do we achieve this?  There is no perfect method for gathering and analyzing requirements  If there was, we'd all be using it  Rather, there are many approaches to choose from…
  • 53.
    REQUIREMENTS GATHERING TECHNIQUES A structured approach to requirements management resolves these problems  Develop SMART objectives which nearly guarantees the success of the project  Scientific approach requires a constant description of all activities, objectives and corrective measures to counter potential loopholes
  • 54.
    REQUIREMENTS GATHERING TECHNIQUES Apprenticing Technique Observes the business users Understands the day to day activities Capture/documents the requirements Get signoff from customer
  • 55.
    REQUIREMENTS GATHERING TECHNIQUES Brainstorming Technique  Idea generation  Idea reduction and voting  Mind Mapping Technique  Use emphasis  Use association  Be clear  Layout  Use Case Workshop Technique  Most popular  Collect requirements in step-by-step manner  Helps understanding the details  Easy to document and written in natural language
  • 56.
    REQUIREMENTS GATHERING TECHNIQUES Interviewing Technique  Fix up the time with business user  Attend the session  Note down the information in notebook Stake Holder 1 Stake Holder 2 ………… Requirements #1 Definition Scope Date of Interview Deadlines and Boundary Requirements #2 Definition Scope Date of Interview Deadlines and Boundary
  • 57.
    REQUIREMENTS GATHERING TECHNIQUES Family Therapy Technique  Refers to all stake holders in the project  Works based on the model  Intake  Meaning  Significance  Response Stake Holder 1 Stake Holder 2 ………… Requirements #1 Intake/Idea Meaning Significance Responses/Consolidations Requirements #2 Intake/Idea Meaning Significance Responses/Consolidations
  • 58.
    REQUIREMENTS GATHERING TECHNIQUES Reusing Requirements Technique  Multiple things are present for single common purpose  Two or more modules have same functionality  Re-use the functionality and save the time  Videos & Photographs Technique  Applies to all type of requirements  When we are not able to understand the requirements  Re-visit the videos & photographs and get more clarity  Prototyping Technique  Screens mock ups  visualize application  Present to customer  Make sure we and customer having same understanding  Prototype functionality not how/what code  Data flow functionality overview
  • 59.
    RELATIVE STRENGTHS INREQUIREMENTS GATHERING TECHNIQUES : Limited Effectiveness : Effective : Very Effective TECHNIQUE CONSCIOUS UNCONSCIOUS UNDREAMED Apprenticing       Brainstorming      Mind Mapping        Use Case Workshops        Interviewing       Family Therapy      Reusing Requirements      Videos & Photographs       Prototyping       
  • 60.
    HOW TO DOCUMENT REQUIREMENTS? RequirementsImportance Requirements Meaning What Should the BA Record?
  • 61.
    REQUIREMENTS IMPORTANCE  RequirementsGathering is about info transferring and sharing  Requirements Document is the project Contract between users & developers  Requirements Document is the first draft of the Project Plan  Requirements Document is used throughout the project from start to delivery by all stakeholders (planning, designing, mockups, testing, acceptance)
  • 62.
    REQUIREMENTS MEANING The RequirementsDocument is… The Business coded version of … The User’s Specifications written using… The Human Programming Language!
  • 63.
    WHAT SHOULD THEBA RECORD?  Stakeholders  Include stakeholders names, titles & signatures  Role in requirements gathering  Role in approval  Problem Statement  Brief idea about the purpose of the project  Overview of problem background & impact of implementation  Business Goals  Helps developer and business stakeholders understanding the goal of the project & sharing the same view
  • 64.
    WHAT SHOULD THEBA RECORD?  Scope  Cleary states what the proposed solution will cover & what it won’t  Determines In Scope & Out of Scope requirements  Assumptions  Helps all stakeholders viewing, as much as possible, the requirement from the same viewpoint  May include business, technical & planning assumptions  Constraints & Risks  Identifies problems facing product implementation at early stages  Facilitates decision making & project planning  May be business and/or technical
  • 65.
    WHAT SHOULD THEBA RECORD?  Pre-requisites  Define project dependencies  Project will not be launched unless they exist  References  Refer to other helper systems or documentation  System Actors/Users  Define users who will have access to the system  Brief description about their roles User/Actor Role Comments Student Review Schedule
  • 66.
    WHAT SHOULD THEBA RECORD?  Business Processes/Workflows  Describe the steps of the business processes  Use swim lanes presentation to illustrate the workflowExpenseReporting AccountantManagerEmployee Submit Expense Report Correct Report ? Issue Payment Write Expense Report Sign Yes No
  • 67.
    WHAT SHOULD THEBA RECORD?  Business ERD (Entity Relationship Diagram)  Relations between objects Division Department EmployeeProject is assigned to operates employs
  • 68.
    WHAT SHOULD THEBA RECORD?  Functional Requirements  Describe each role/function clearly  Functionality, fields & actions Field Name Description Type Linked To Default Value Constraint/ Validation U n i q u e V i s i b l e R e q u ir e d Comments Subject The name of the subject Text    Date … Date Should exclude week ends   Time … Time   Action Name Description Type Comments View Opens a new page with the details of the schedule Button Display a warning message to save changed data
  • 69.
    WHAT SHOULD THEBA RECORD?  Use Cases  “An end to end sequence of interactions between an actor and a system that yields a result of observable value to an actor”  Written as a flow or sequence of steps  Actor does something  System does something  Actor does something else  System does something else  Made up of one main flow and a number of alternate and/or exception flows (some of which can branch back to the main flow)
  • 70.
    WHAT SHOULD THEBA RECORD?  Use Cases Waiter Client Cashier Chef Order Food Serve Food Eat Food Pay for Food Order Water Cook Food Drink Water Pay for Water Serve Water Receive order Accept payment Pay Facilitate payment Place order Confirm order <<extend>> <<extend>> <<extend>> <<extend>> {if water was consumed} {if water was served} {if water was ordered}
  • 71.
    WHAT SHOULD THEBA RECORD?  User Stories (Agile Projects)  A tool to support the iterative and incremental approach  Provide a framework where the detail can be added as it is needed, just enough and just in time  Sentences described in everyday or business language  Captures 'who', 'what' & 'why' of a requirement  Limited in detail by what can be hand-written on a small paper notecard
  • 72.
    WHAT SHOULD THEBA RECORD?  User Stories (Agile Projects)
  • 73.
    WHAT SHOULD THEBA RECORD?  Reporting Requirements  What reports are needed  Business need  Report name, filters, output, header, footer  GUI Requirements  Describes the needed user graphical interface  Look & feel
  • 74.
    WHAT SHOULD THEBA RECORD?  Non-functional Requirements  Hardware & software requirements  Performance, number of normal & concurrent users  Page response time  Usability, cultural aspects  Availability, reliability, maintainability, extensibility, security…  Open Issues/Pending Decision/Questions  Help getting quick & precise answers to vague requirements ID Question Owner Type Answer Status Priority Open Date Target Date 36 Will all students have the same schedule view? SH1 Business clarification Yes Closed High 6-Jun 10-Jun
  • 75.
    MATCHING REQUIREMENTS WITH USEREXPERIENCE What Is UX? Where Does UX Come? Elements of UX Design
  • 76.
    WHAT IS UX? How a person feels when interfacing with a system  UX designers study and evaluate how users feel about a system  Ease of use  Perception of the value of the system  Efficiency in performing tasks…  UX deals with users’ needs
  • 77.
    WHERE DOES UXCOME? Business System Users High Level Detail • Sponsor point of view • Scope of the project • Business objective • User point of view • User goals • User inputs & outputs • Functional • Non-functional
  • 78.
  • 79.
    EXAMPLE  App: Facebook Feature: Invite friend(s) to an event  Requirements  Display the list of friends  Select friend(s) from the list  Confirm action  Cancel action  UX…
  • 80.
  • 81.
    TOWARDS A BETTEROUTPUT Guidelines Tips
  • 82.
    GUIDELINES Users don't knowwhat they want until you show it to them
  • 83.
    GUIDELINES:1  Focus &clarity  Clearly state the objective & define the scope  Clarify what the project does and does not cover  A format for specifying requirements  Use whichever method works for you  Understanding is the most important outcome  Not all formats of requirements documentation are equal  Requirements document author  Writing skills  Balance understanding the project domain against understanding the process of software development
  • 84.
    GUIDELINES:2  Requirements language Use the same language as your client  If the language is consistent, it greatly lowers the risk of requirements misinterpretation  Accuracy is critical  Accurately reflect client needs  Walk the client through the requirements  It costs more to fix things in testing than in the requirements phase  Minimize the risk of errant interpretation  Ensure everyone has the same understanding  Use diagrams, pictures, or sample data illustrating requirements meaning
  • 85.
    TIPS You never realizeuntil you’ve been there!
  • 86.
    TIPS:1 Build trust inyour experience & knowledge  Understand the business domain  Act as a subject matter expert  Be your client’s consultant  Network and build relations  Set correct expectation  Give space for yourself  Never promise before getting back to your team  Educate your client
  • 87.
    TIPS:2 Add value  Don’tjust simulate what’s on the paper  Understand the goals/needs  Deliver an intelligent output  Suggest improvements  Challenge requirements with yourself then with your client
  • 88.
    TIPS:3 Convince & influence Select your communication medium  Know what to say, when and to whom  Ask smart questions  Have empathy with your client and team members
  • 89.
    TIPS:4 Protect the idea Do whatever it takes to deliver the idea  Use visuals and illustrate with charts, WBS and drawings  Make it easy to trace and understand things  Use examples and build scenarios  Keep the business goal in mind and explain it to your team
  • 90.
    TIPS:5 Ask for assistance& be aware  Refer to developers for advice, feasibility and verification  Keep the PM updated  Understand the impact of additions on effort and cost  Know when to say No!
  • 91.
    TIPS:6 Dig deeper  Analyze,analyze, analyze  Think about ways to group similar components  Identify re-usable components and data
  • 92.
    TIPS:7 Organize  Use mindmaps  Track changes in your documents  Track versions and brief about change history  Document naming convention
  • 93.
    TIPS:8 Plan  Your meetings Your questions  When to discuss which features/requirements  Use reminders, emails, summaries, agendas and meeting minutes  Prioritize in case of shortage in time and budget
  • 94.
    TIPS:9 Be productive  Saveyour time and others’ time  Eliminate paper and pen usage  Document everything then select what to use  Share online  Minimize possibilities of re-work  Take lead and be in control
  • 95.
    CONCLUSION Continuous effort toimprove the quality of software development activities
  • 96.
    CONCLUSION  There isno silver bullet, no one answer, no perfect approach method or technique to requirements gathering  Developing a good requirements document is about giving your project the best chance of success  To do so, you must reduce the risk of common mistakes that arise from a lack of communication or understanding  Keep this in mind as you gather your requirements that project will have the best chance of success
  • 97.
    THE WORKSHOP No physicianis really good before he has killed one or two patients ~Hindu Proverb
  • 98.
    ACTIVITIES  Meeting withclient  Develop  Requirements document  Presentation for the top management approval  Review deliverables together  Evaluation  Team will evaluate each other  Mentor’s evaluation
  • 99.
    WHAT WE WILLEVALUATE  Requirements  Taking care of all requirements  Clearness of requirements in head  Ability to answer questions  Maintaining scope  Using examples  Adding value  Challenging input  Asking meaningful questions  Management  On time delivery  Decision making  Signoff  Overall  Being productive  Maintaining professional image  Ability to convince & influence
  • 100.
  • 101.
    LET’S KEEP INTOUCH  Twitter: @menameissa  Blog: A Project Manager’s Diary  Slide Share presentation: http://www.slideshare.net/menameissa/business- requirements-gathering-and-analysis
  • 102.
  • 103.
  • 104.
    REFERENCES  http://www.techwr- l.com/techwhirl/magazine/writing/softwarerequirementspecs.html  http://www.code-magazine.com/Article.aspx?quickid=0102061 http://www.codeproject.com/useritems/Requirement_Gathering.asp  http://www.umsl.edu/~sauterv/analysis/random_analysis_thoughts.html  http://www.project-portfolio-management-blog.com/2007/03/13/getting-the- project-requirements-right/  http://en.wikipedia.org/wiki/Requirements_analysis  http://www.sitepoint.com/article/requirements-gathering  http://www.bajob.ca/businessanalyst-job/business-analyst-skills-a4.html  http://www.esi-intl.com/courses-and-certifications/courses/project- management/requirements-management-a-key-to-project-success  http://johnnyholland.org/2011/06/matching-requirements-with-user- experience/
  • 105.
    REFERENCES  http://smallbusiness.chron.com/functional-requirements-vs-business-requirements- 65938.html  http://www.advstr.com/web/resources/downloads/Defining_Requirements.pdf http://www.accompa.com/kb/answer.html?answer_id=170  http://rmblog.accompa.com/2012/06/features-vs-use-cases-vs-requirements/  http://www.businessanalystsolutions.com/what_is_a_business_analyst.html  http://www.villanovau.com/resources/business-analysis/business-analyst-job- description/#.VSqagRCUftI  http://en.wikipedia.org/wiki/Verification_and_tion  http://www.ppmstudio.com/Solutions_ApplicationLifecycleManagement.aspx  http://www.iai.uni- bonn.de/III/lehre/vorlesungen/SWT/RE05/slides/08_Requirements%20Manageme nt.pdf  http://www.projectsmart.co.uk/smart-goals.php  http://www.wikihow.com/Write-a-Requirements-Document  http://www.bridging-the-gap.com/what-requirements-specifications-do-business- analysts-create/
  • 106.
    REFERENCES  http://www.conceptdraw.com/How-To-Guide/swim-lane  http://info.slis.indiana.edu/~dingying/Teaching/S511/new/labs/lab5.htm http://en.wikipedia.org/wiki/Scope_creep  http://pmblog.accompa.com/2009/09/22/use-cases-top-10-reasons-for-using-them- to-document-your-requirements/  http://en.wikipedia.org/wiki/User_story  http://www.batimes.com/articles/user-stories-and-use-cases-dont-use-both.html  http://en.wikipedia.org/wiki/Use_case  http://winnipegagilist.blogspot.com/2012/03/how-to-create-user-story-map.html  http://www.smashingmagazine.com/2010/10/05/what-is-user-experience-design- overview-tools-and-resources/  http://usabilitygeek.com/requirements-gathering-user-experience-pt1/  http://www.bridging-the-gap.com/what-a-ba-should-know-about-the-ux-profession- interview-with-patrick-quattlebaum/  https://www.pinterest.com/pin/222294931583422543/  http://www.liquid-code.net/  http://www.quotegarden.com/experience.html
