ASAP 8
Deep Dive into Methodology Framework for SAP Projects and
services
Jan Musil, Global Lead of PM Practice - SAP Services

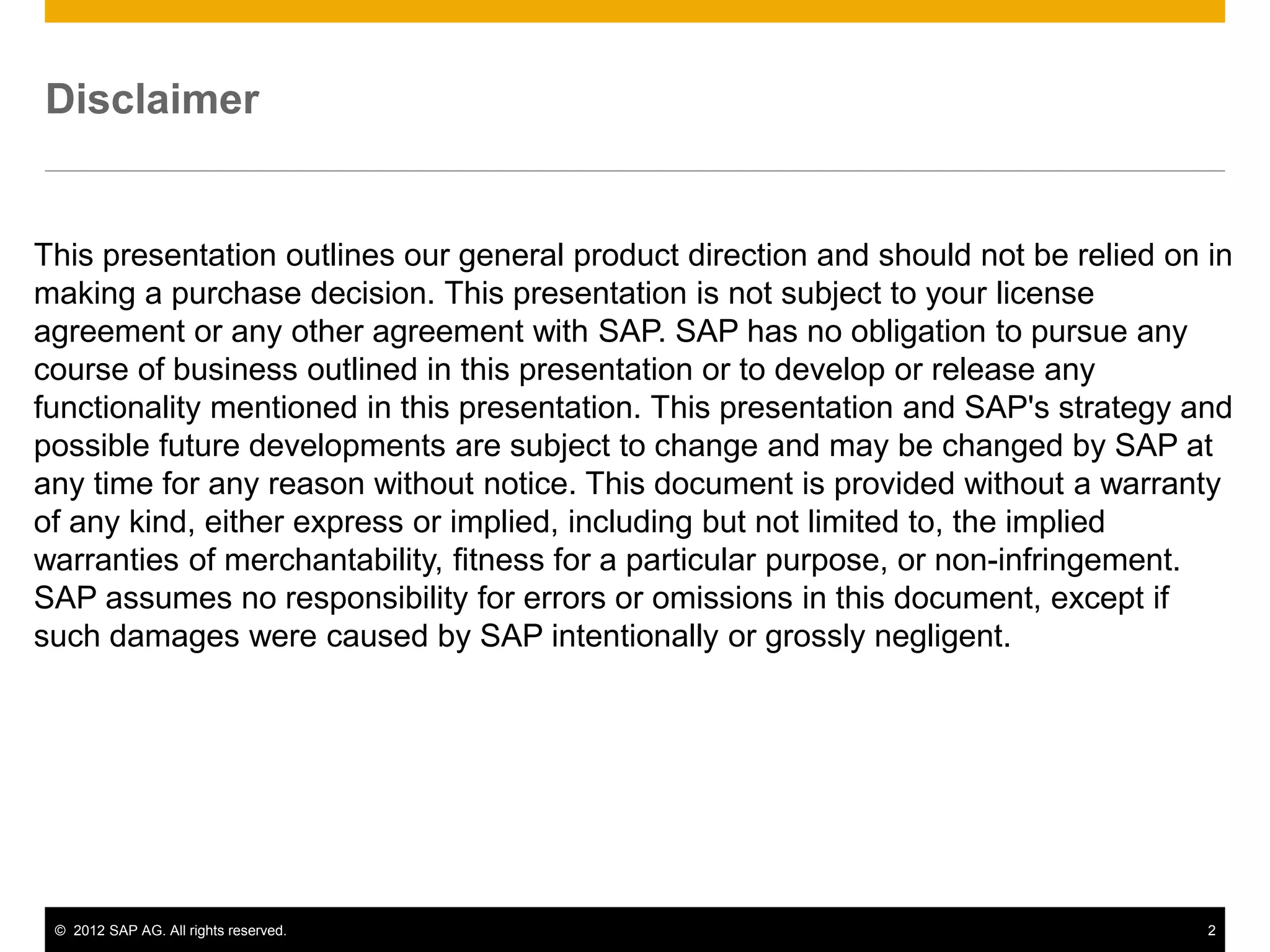

Disclaimer

This presentation outlines our general product direction and should not be relied on in
making a purchase decision. This presentation is not subject to your license
agreement or any other agreement with SAP. SAP has no obligation to pursue any
course of business outlined in this presentation or to develop or release any
functionality mentioned in this presentation. This presentation and SAP's strategy and
possible future developments are subject to change and may be changed by SAP at
any time for any reason without notice. This document is provided without a warranty
of any kind, either express or implied, including but not limited to, the implied
warranties of merchantability, fitness for a particular purpose, or non-infringement.
SAP assumes no responsibility for errors or omissions in this document, except if
such damages were caused by SAP intentionally or grossly negligent.

 © 2012 SAP AG. All rights reserved.                                                 2
Your presenter

                                      Jan Musil, SAP America
                                      Global lead of SAP Project Management Practice

© 2012 SAP AG. All rights reserved.                                                    3
Outline of what we will cover

Purpose of the Presentation

• Review SAP’s Advanced Delivery
  Management concept
• Introduce ASAP 8 Methodology
• Outline how SAP designs services
  with ASAP 8
• What’s new in ASAP 8
• How to access the methodology
• Demo of ASAP 8

© 2012 SAP AG. All rights reserved.   4
What is SAP Advanced Delivery
Management
With New Delivery Approach we …

                                      … ensure the most predictable and fastest time
                                      to business value

                                      … deliver the integration the business demands
                                      to start and grow without compromises

                                      … choose from a modular ready to use portfolio of
                                      solution, deployment and pricing options

                                      … innovate faster than competitors and leverage
                                      the full potential of the game changers

© 2012 SAP AG. All rights reserved.                                                     6

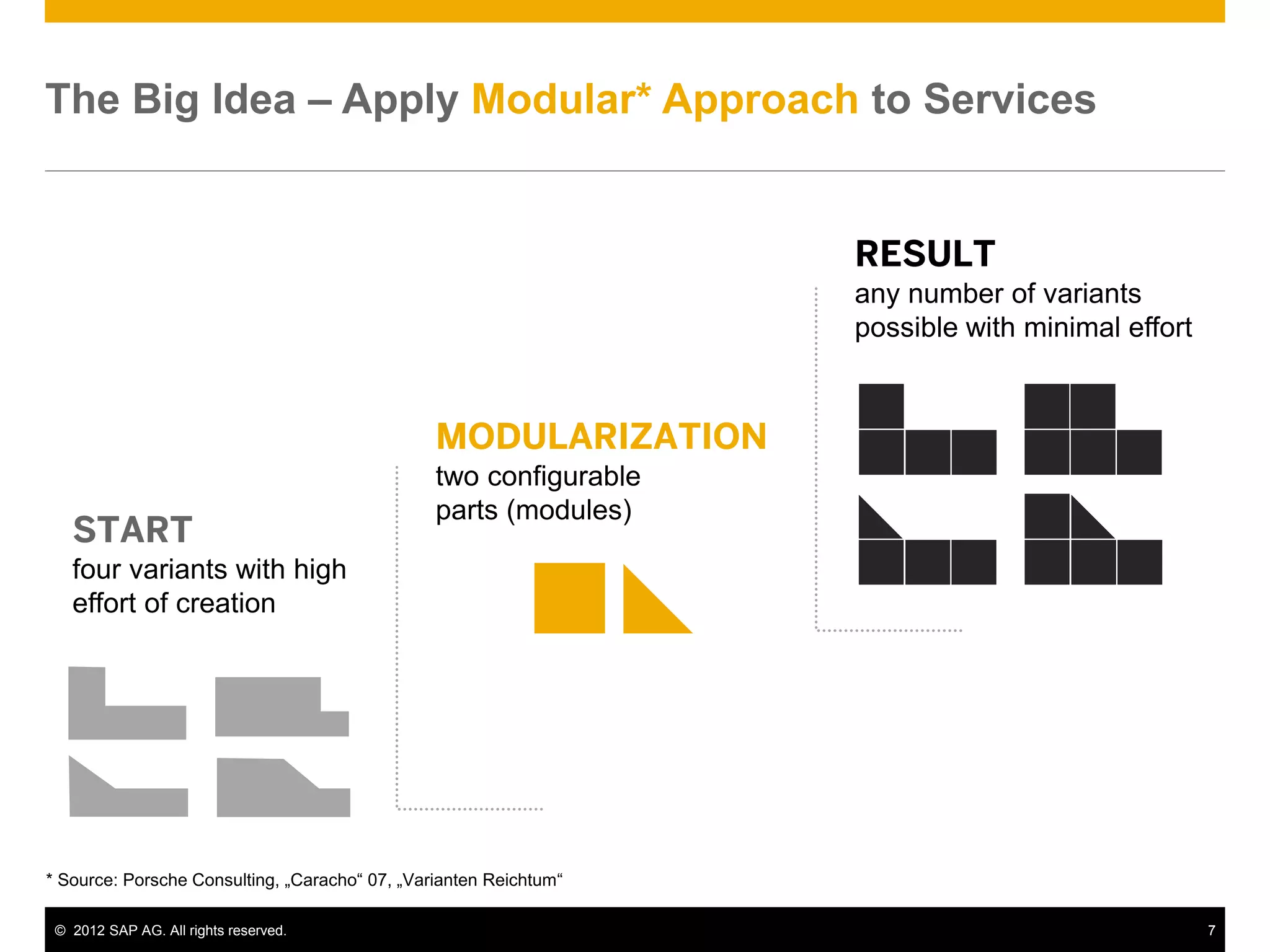

The Big Idea – Apply Modular* Approach to Services

                                                                   RESULT
                                                                   any number of variants
                                                                   possible with minimal effort

                                                MODULARIZATION
                                                two configurable
                                                parts (modules)
   START
   four variants with high
   effort of creation

* Source: Porsche Consulting, „Caracho“ 07, „Varianten Reichtum“

 © 2012 SAP AG. All rights reserved.                                                              7

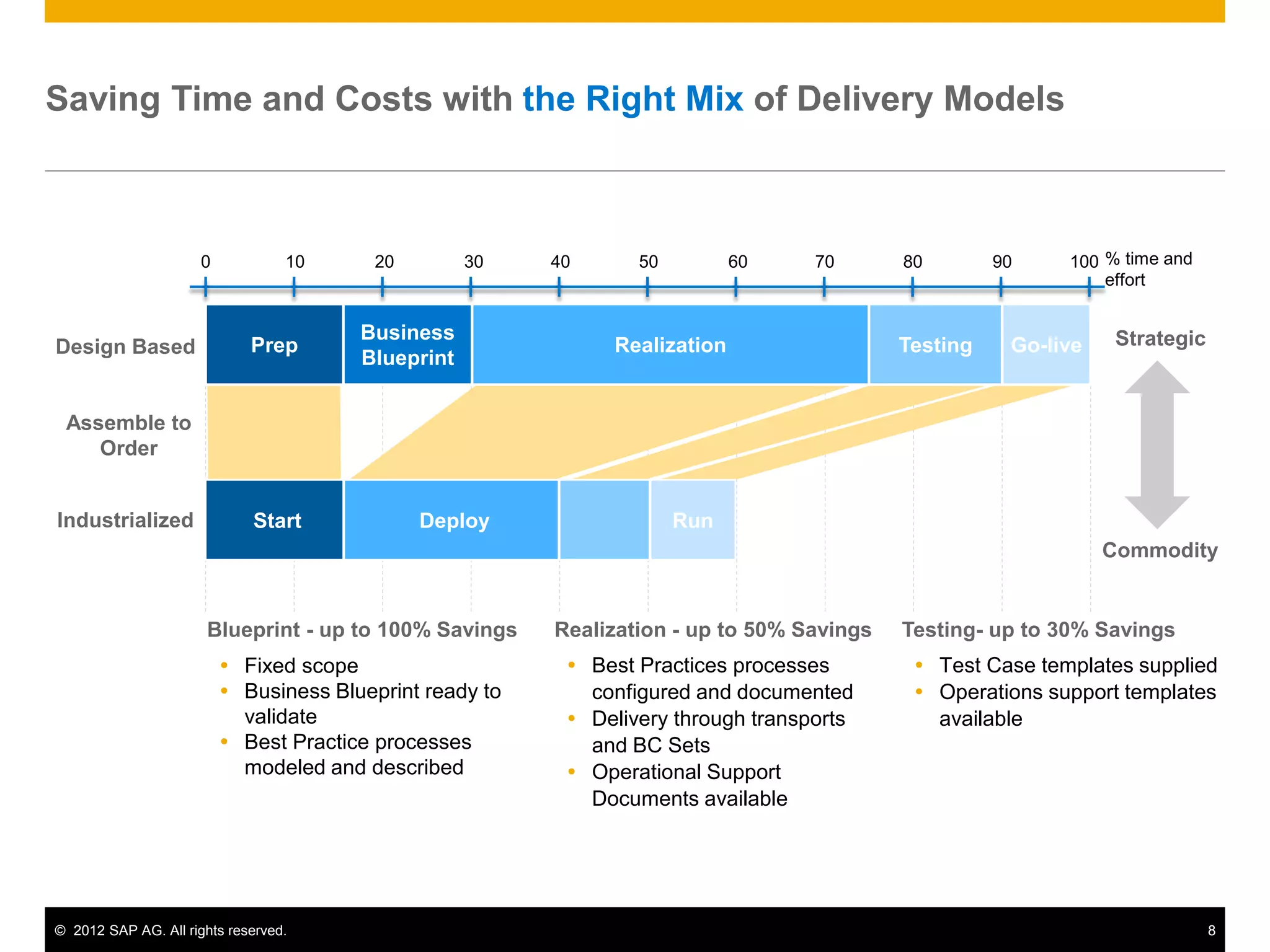

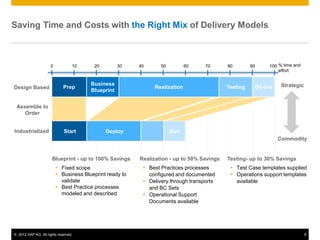

Saving Time and Costs with the Right Mix of Delivery Models

                      0           10     20         30    40      50         60     70      80        90    100 % time and
                                                                                                                effort

                                        Business                                                                  Strategic
Design Based                 Prep                              Realization                  Testing    Go-live
                                        Blueprint

 Assemble to
    Order

Industrialized               Start            Deploy                   Run
                                                                                                                 Commodity

                      Blueprint - up to 100% Savings      Realization - up to 50% Savings   Testing- up to 30% Savings
                           Fixed scope                     Best Practices processes         Test Case templates supplied
                           Business Blueprint ready to      configured and documented        Operations support templates
                            validate                        Delivery through transports       available
                           Best Practice processes          and BC Sets
                            modeled and described           Operational Support
                                                             Documents available

© 2012 SAP AG. All rights reserved.                                                                                           8

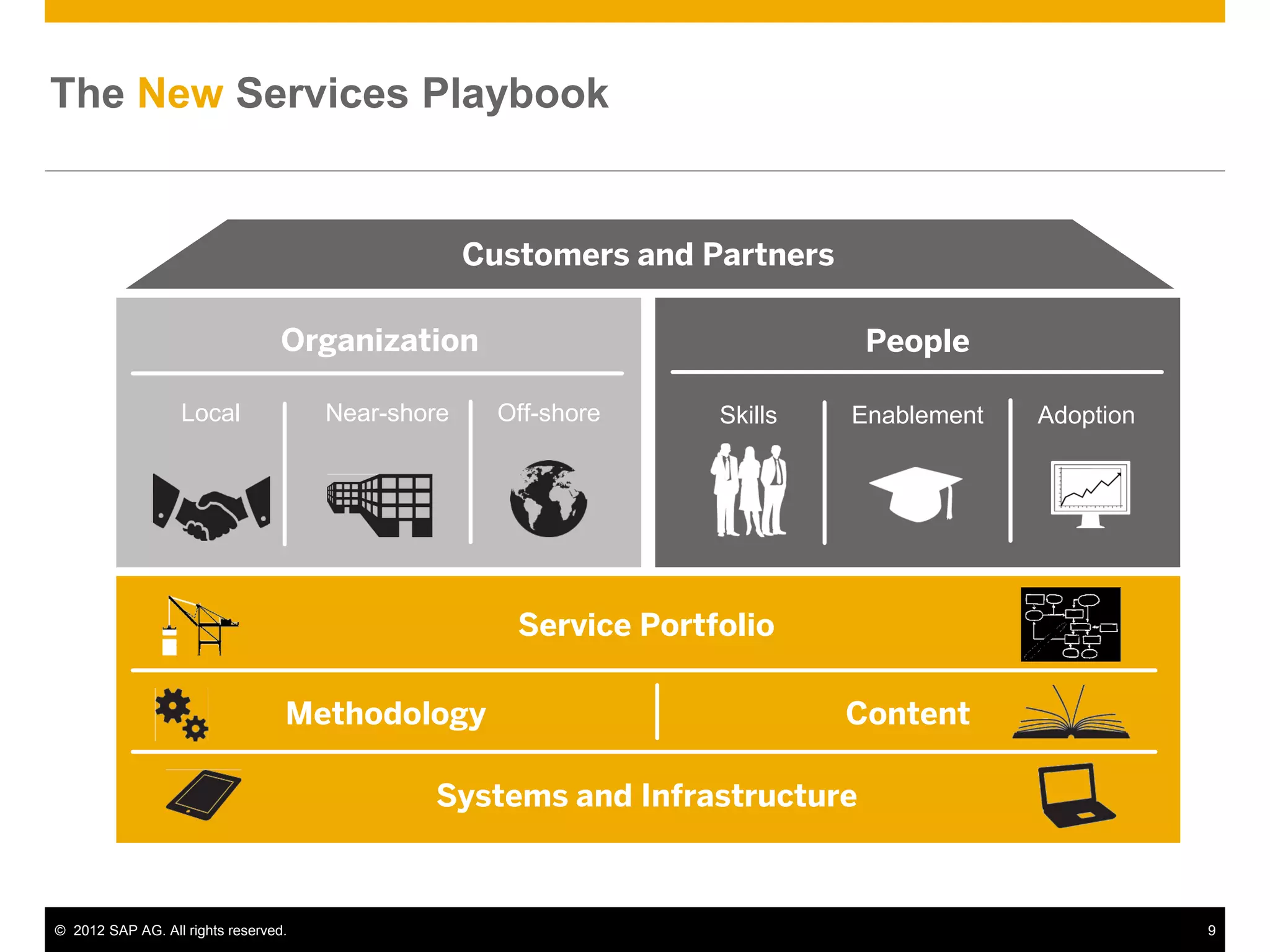

The New Services Playbook

                                                   Customers and Partners

                                  Organization                               People

                   Local              Near-shore     Off-shore     Skills   Enablement   Adoption

                                                      Service Portfolio

                                  Methodology                               Content

                                              Systems and Infrastructure

© 2012 SAP AG. All rights reserved.                                                                 9
Introducing ASAP 8 Methodology

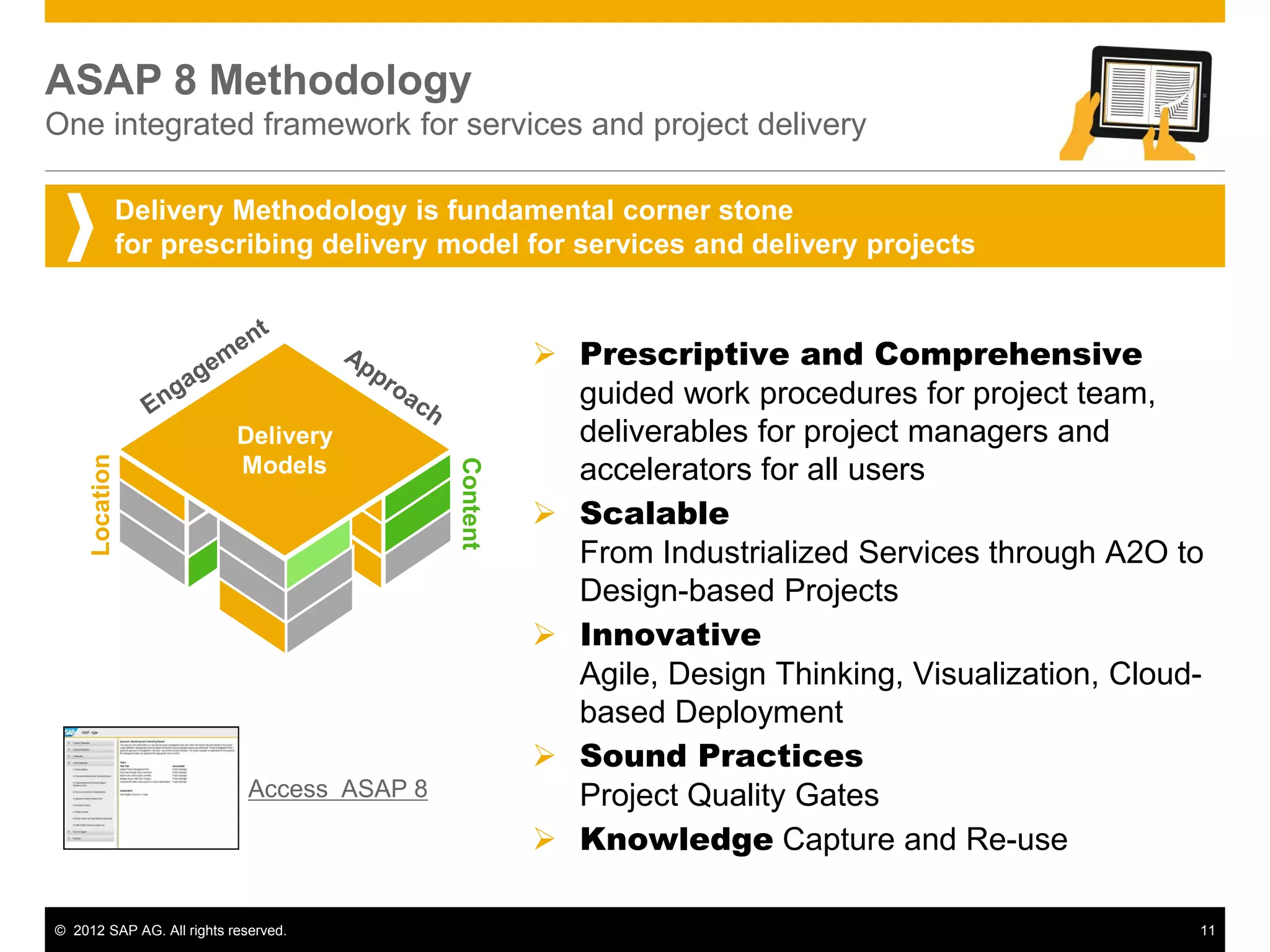

ASAP 8 Methodology
One integrated framework for services and project delivery

                Delivery Methodology is fundamental corner stone
                for prescribing delivery model for services and delivery projects

                                                        Prescriptive and Comprehensive
                                                         guided work procedures for project team,
                           Delivery                      deliverables for project managers and
                                                         accelerators for all users
     Location

                           Models            Content

                                                        Scalable
                                                         From Industrialized Services through A2O to
                                                         Design-based Projects
                                                        Innovative
                                                         Agile, Design Thinking, Visualization, Cloud-
                                                         based Deployment
                                                        Sound Practices
                             Access ASAP 8               Project Quality Gates
                                                        Knowledge Capture and Re-use

© 2012 SAP AG. All rights reserved.                                                                  11

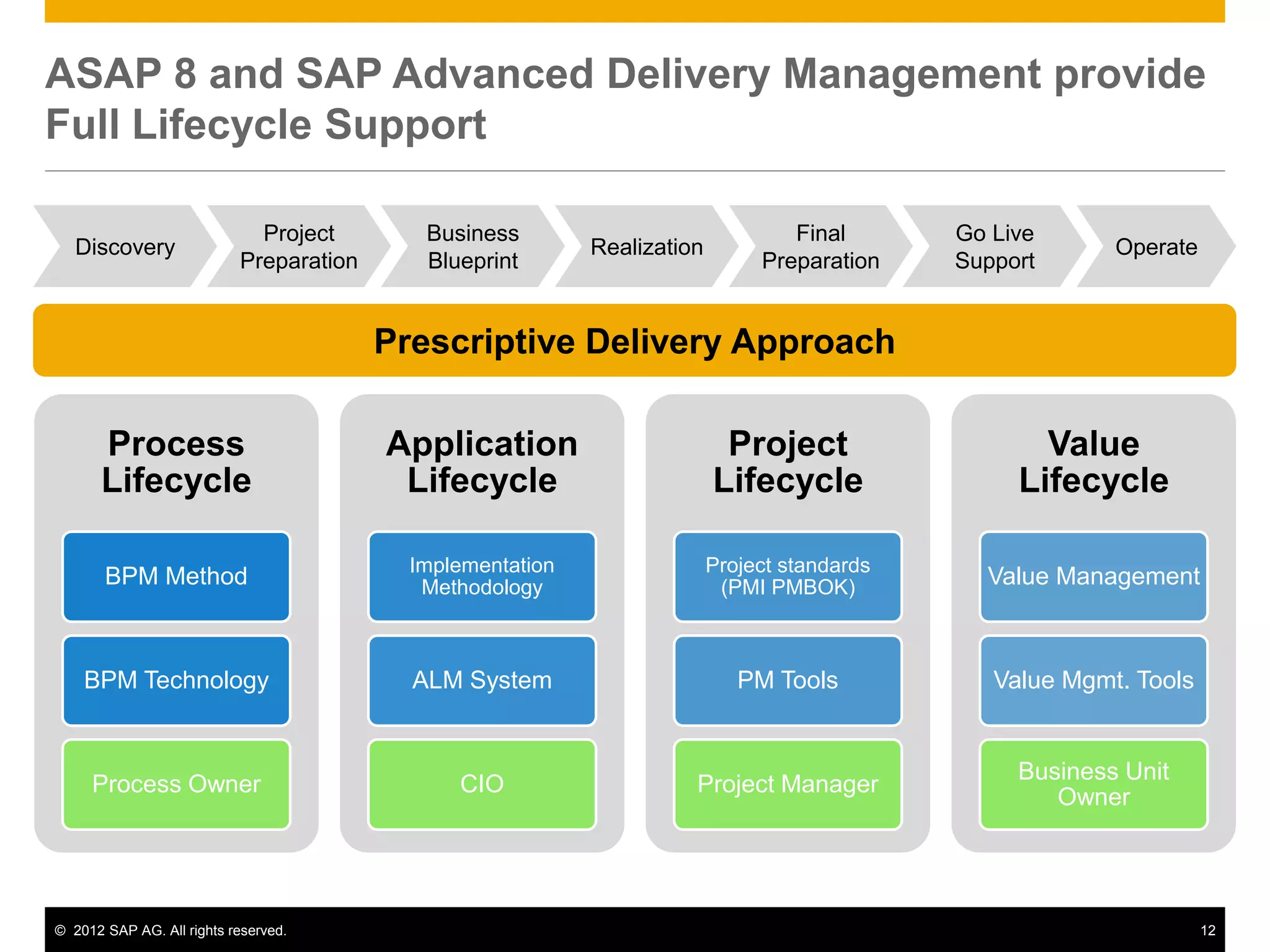

ASAP 8 and SAP Advanced Delivery Management provide
Full Lifecycle Support

                             Project        Business                              Final       Go Live
   Discovery                                                Realization                                    Operate
                           Preparation      Blueprint                          Preparation    Support

                                         Prescriptive Delivery Approach

      Process                            Application                       Project                   Value
      Lifecycle                           Lifecycle                       Lifecycle                Lifecycle

                                           Implementation                 Project standards
       BPM Method                           Methodology                    (PMI PMBOK)          Value Management

    BPM Technology                         ALM System                        PM Tools            Value Mgmt. Tools

                                                                                                   Business Unit
     Process Owner                             CIO                    Project Manager
                                                                                                      Owner

© 2012 SAP AG. All rights reserved.                                                                                  12

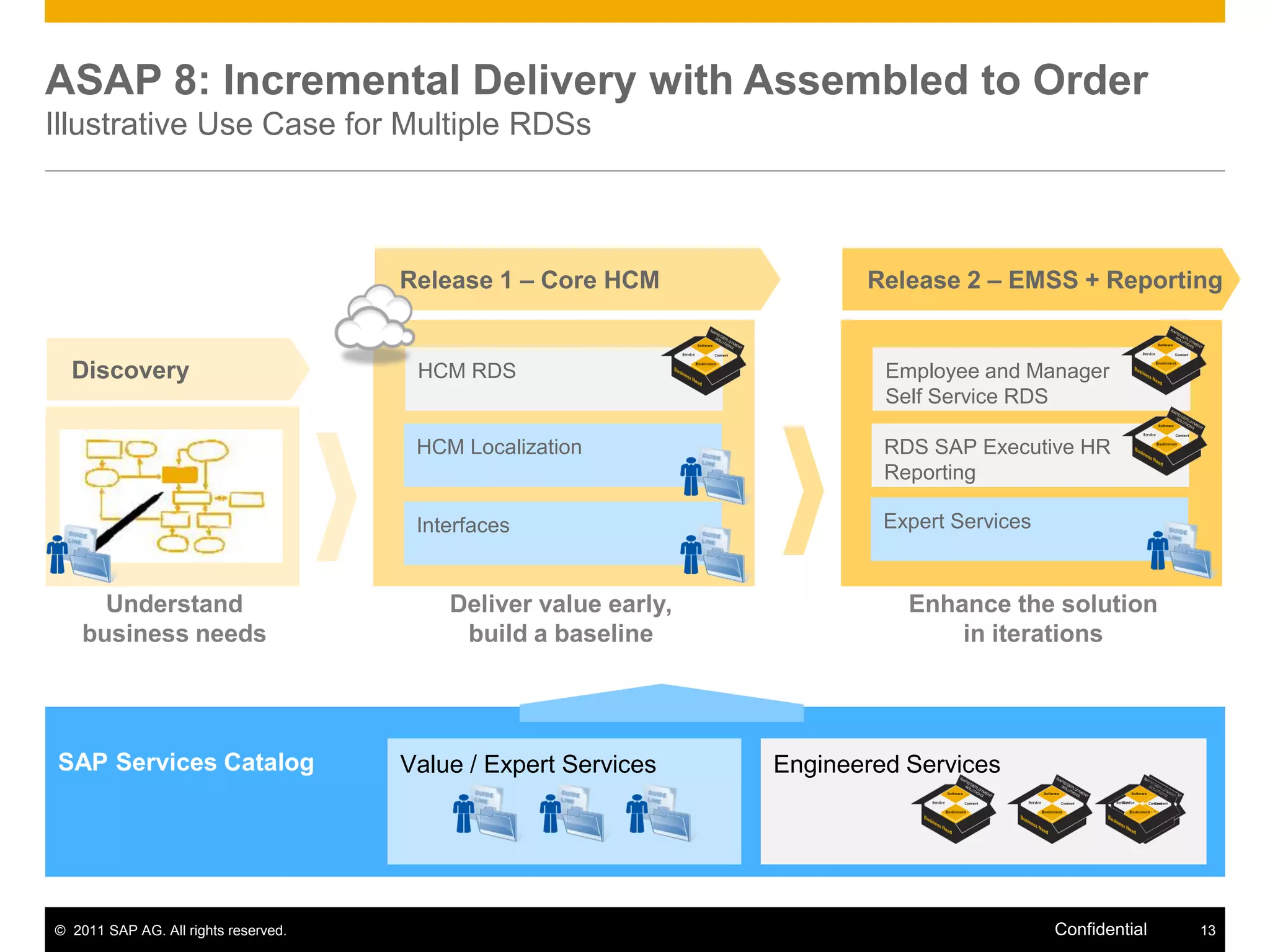

ASAP 8: Incremental Delivery with Assembled to Order
Illustrative Use Case for Multiple RDSs

                                      Release 1 – Core HCM              Release 2 – EMSS + Reporting

  Discovery                            HCM RDS                            Employee and Manager
                                                                          Self Service RDS

                                       HCM Localization                   RDS SAP Executive HR
                                                                          Reporting

                                       Interfaces                         Expert Services

      Understand                          Deliver value early,              Enhance the solution
    business needs                         build a baseline                     in iterations

SAP Services Catalog                  Value / Expert Services    Engineered Services

© 2011 SAP AG. All rights reserved.                                                         Confidential   13

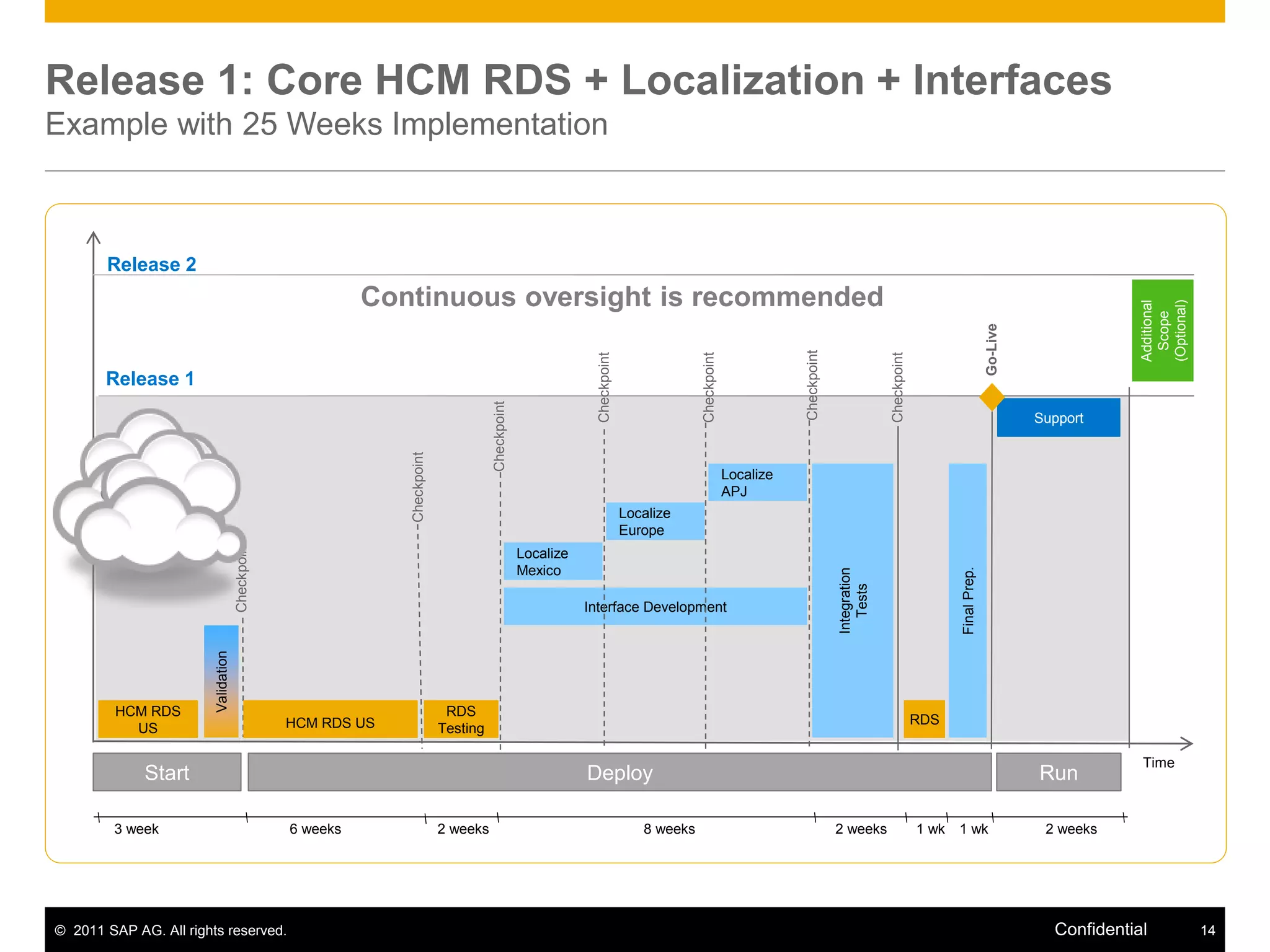

Release 1: Core HCM RDS + Localization + Interfaces
Example with 25 Weeks Implementation

       Release 2
                                                           Continuous oversight is recommended

                                                                                                                                                                                                                                                   (Optional)
                                                                                                                                                                                                                                                   Additional
                                                                                                                                                                                                                                                     Scope
                                                                                                                                                                                                                             Go-Live
                                                                                                                                                                Checkpoint
                                                                                                              Checkpoint

                                                                                                                                        Checkpoint

                                                                                                                                                                                           Checkpoint
       Release 1

                                                                                     Checkpoint
                                                              Checkpoint                                                                                                                                                               Support

                                                                                                                                                     Localize
      Cloud                                                                                                                                          APJ
    ECC6 EP5                                                                                                               Localize
                                                                                                                           Europe
                                    Checkpoint

                                                                                                  Localize
                                                                                                  Mexico

                                                                                                                                                                                                               Final Prep.
                                                                                                                                                                             Integration
                                                                                                                                                                                Tests
                                                                                                             Interface Development
                       Validation

         HCM RDS                                                            RDS
                                                 HCM RDS US                                                                                                                                             RDS
           US                                                              Testing

                                                                                                                                                                                                                                                    Time
             Start                                                                                           Deploy                                                                                                                    Run

        3 week                                   6 weeks                   2 weeks                                            8 weeks                                        2 weeks                    1 wk   1 wk                     2 weeks

© 2011 SAP AG. All rights reserved.                                                                                                                                                                                                      Confidential           14

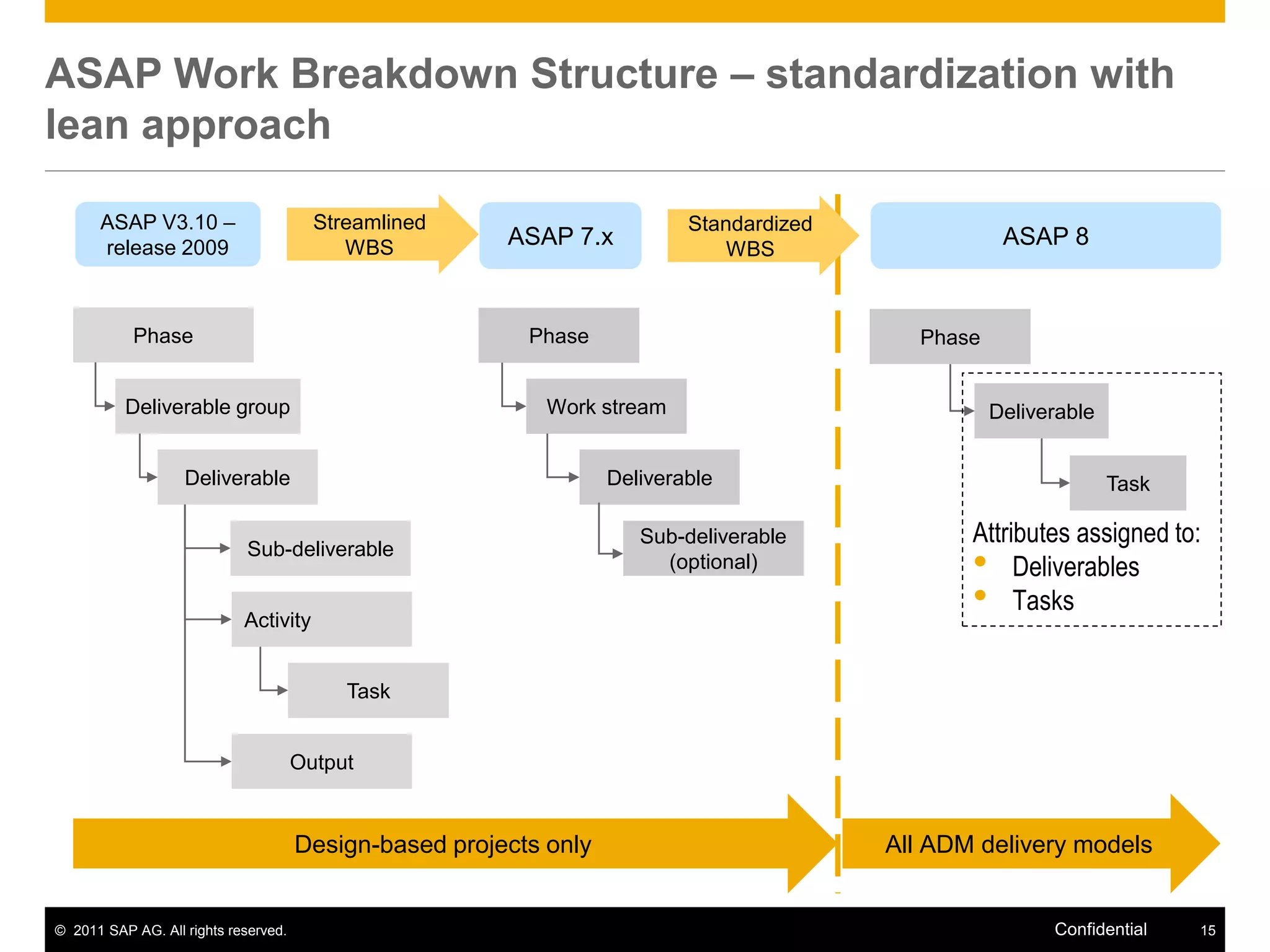

ASAP Work Breakdown Structure – standardization with
lean approach

      ASAP V3.10 –                      Streamlined                        Standardized
      release 2009                         WBS          ASAP 7.x               WBS
                                                                                                      ASAP 8

           Phase                                          Phase                              Phase

          Deliverable group                                 Work stream                              Deliverable

                   Deliverable                                     Deliverable                                     Task

                                                                      Sub-deliverable            Attributes assigned to:
                             Sub-deliverable
                                                                        (optional)               • Deliverables
                            Activity
                                                                                                 • Tasks

                                           Task

                                      Output

                                      Design-based projects only                          All ADM delivery models

© 2011 SAP AG. All rights reserved.                                                                        Confidential   15

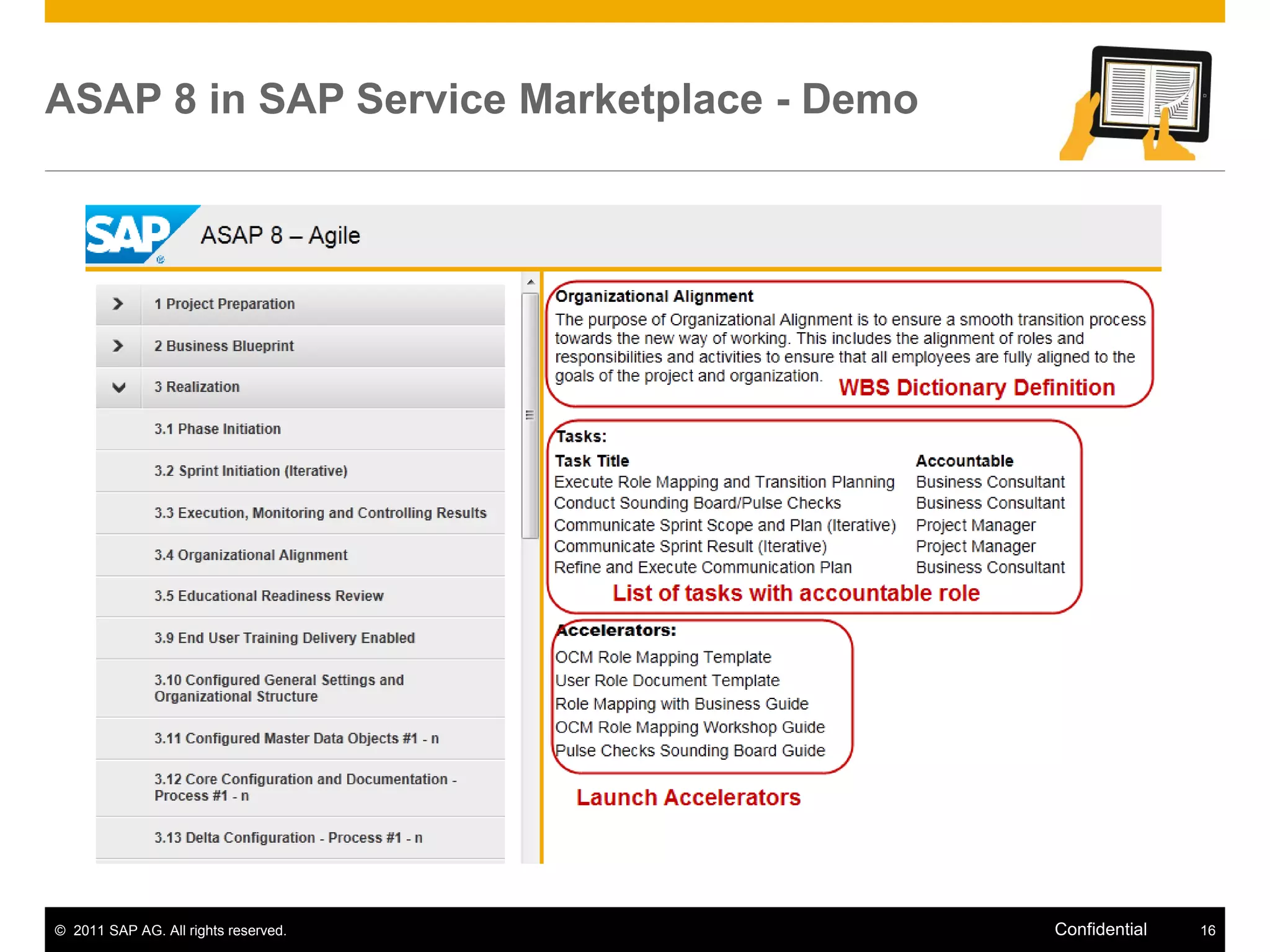

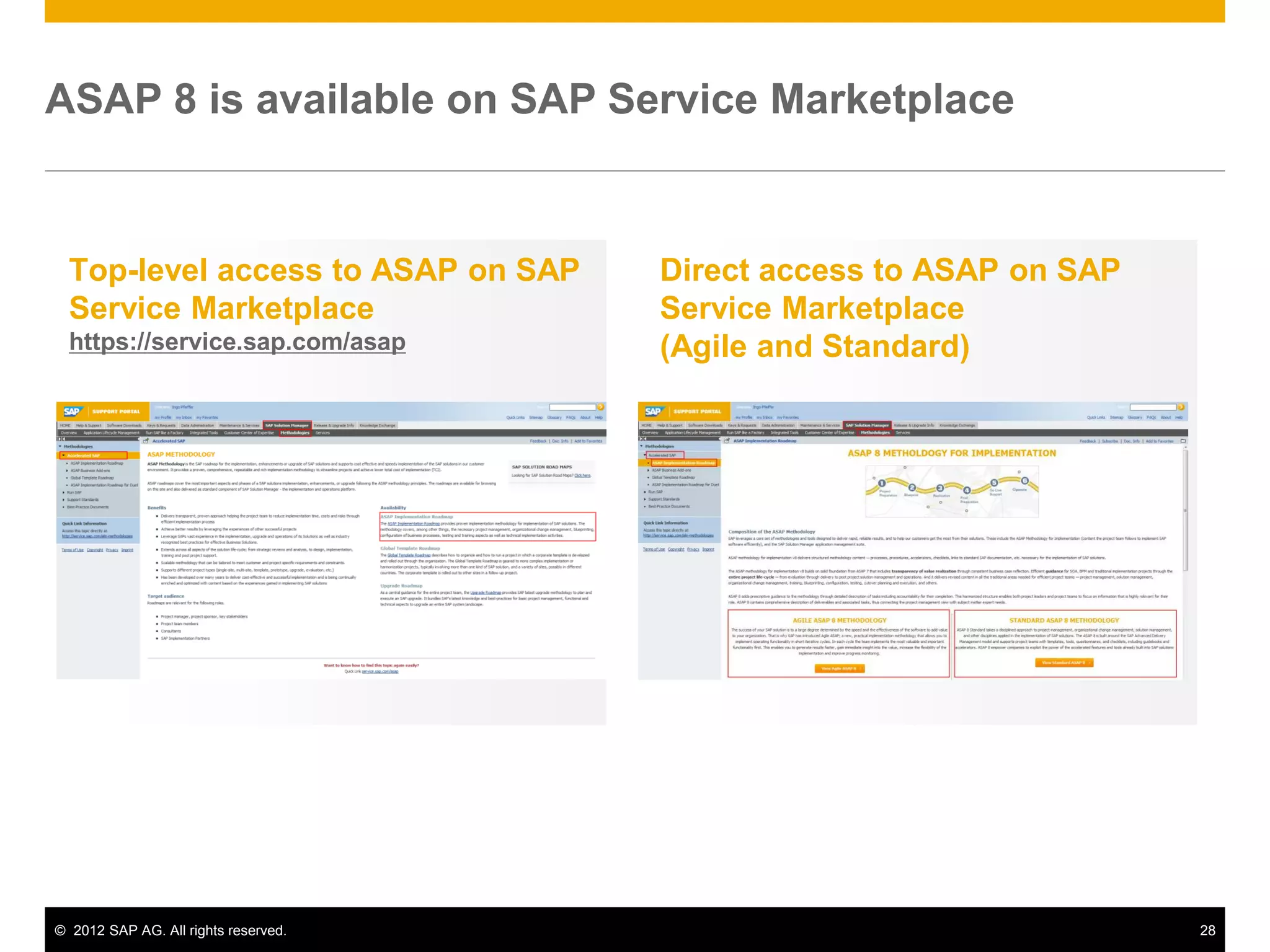

ASAP 8 in SAP Service Marketplace - Demo

© 2011 SAP AG. All rights reserved.        Confidential   16
Overview of Service Design
with ASAP 8

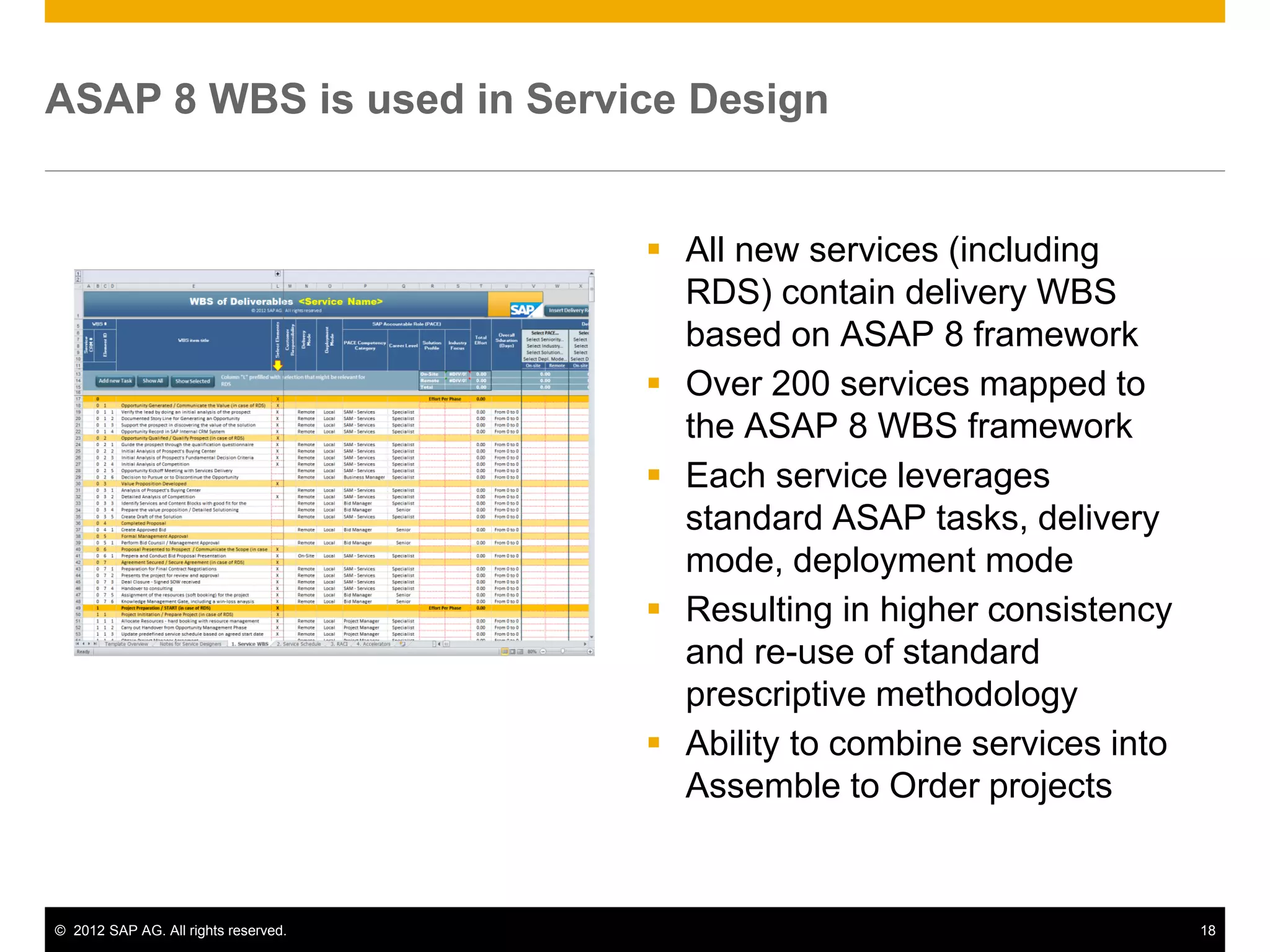

ASAP 8 WBS is used in Service Design

                                       All new services (including
                                        RDS) contain delivery WBS
                                        based on ASAP 8 framework
                                       Over 200 services mapped to
                                        the ASAP 8 WBS framework
                                       Each service leverages
                                        standard ASAP tasks, delivery
                                        mode, deployment mode
                                       Resulting in higher consistency
                                        and re-use of standard
                                        prescriptive methodology
                                       Ability to combine services into
                                        Assemble to Order projects

© 2012 SAP AG. All rights reserved.                                        18

What’s New in ASAP 8
Key Improvements
Overview of enhancements in ASAP 8

                                       ASAP WBS streamlined to 3 levels with
                                        prescriptive delivery attributes (accountability,
                                        delivery mode, etc.).
                                       ASAP 8 became framework for different
                                        deployment strategies – RDS, A2O, Traditional,
                                        Agile.
                                       Improvements in Quality Gate concept and
                                        templates (RDS + Traditional)
                                       Agile, iRise and Design Thinking guidance
                                        built into ASAP
                                       Operate phase aligned to Application Lifecycle
                                        Management processes
                                       Work Stream structure refined
                                       New and Updated Accelerators

© 2012 SAP AG. All rights reserved.                                                     20

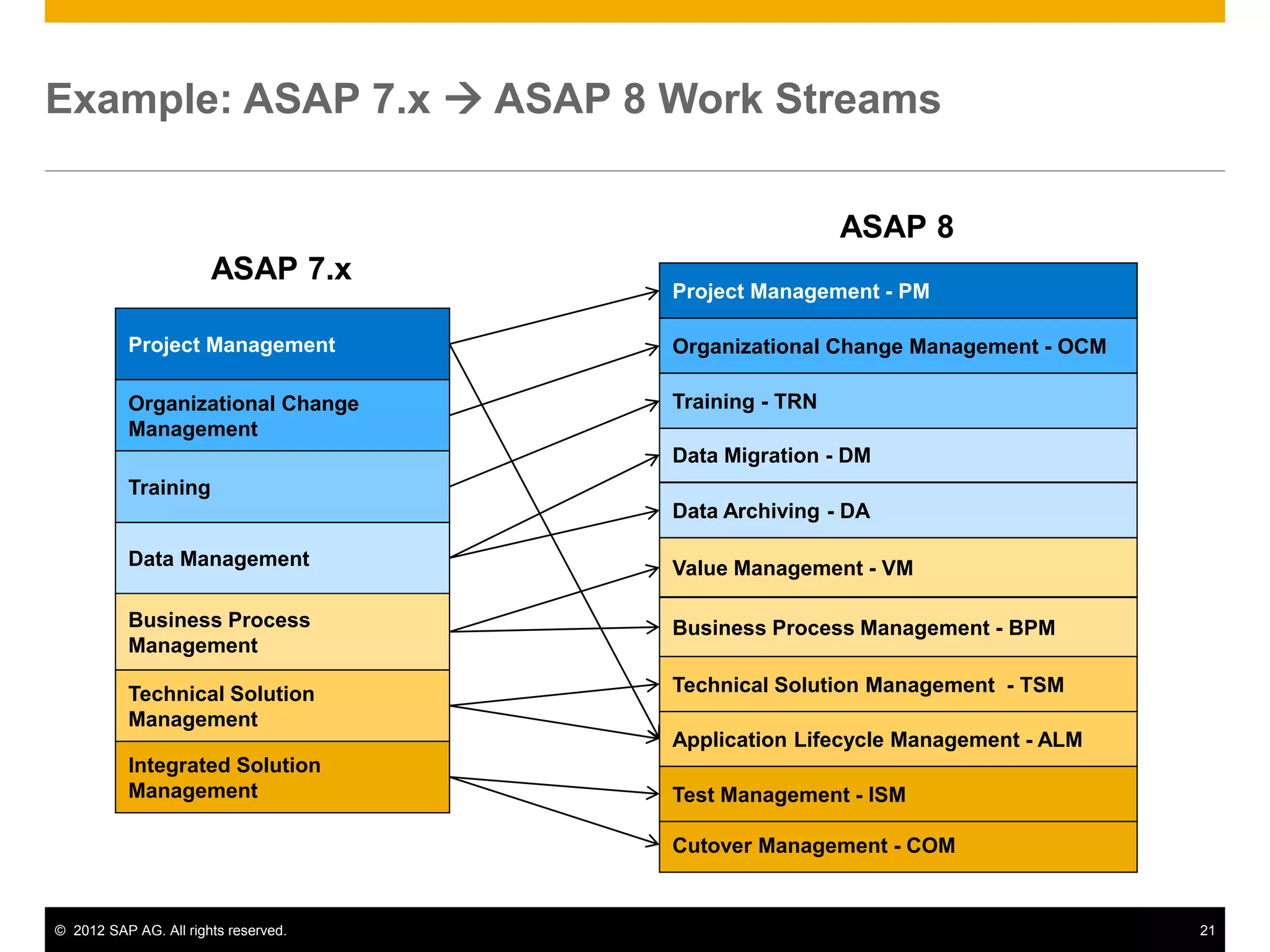

Example: ASAP 7.x  ASAP 8 Work Streams

                                                       ASAP 8
                       ASAP 7.x
                                      Project Management - PM

           Project Management         Organizational Change Management - OCM

           Organizational Change      Training - TRN
           Management
                                      Data Migration - DM
           Training
                                      Data Archiving - DA

           Data Management            Value Management - VM

           Business Process           Business Process Management - BPM
           Management

           Technical Solution         Technical Solution Management - TSM
           Management
                                      Application Lifecycle Management - ALM
           Integrated Solution
           Management                 Test Management - ISM

                                      Cutover Management - COM

© 2012 SAP AG. All rights reserved.                                            21

ASAP 8 in SAP Delivery Projects
How we Deliver
   Clear Work Breakdown and Assignment

                               Discovery                                                Deliver Services

                                                            Initiate           Plan         Execute        Monitor &       Close
                                                            Project           Project       Project      Control Project   Project

                  Services in a
                                                                                  Project WBS
                 Service Portfolio

                                                   ASAP8
                                                                                                                             Iterative
Customer Needs

                                                                                                                            Deployment

                                                                                                                            Solution Demos
                                                                                                                             Visualizations

                                                     Deliverable /                               Roles
                                                            Task                                 Responsibilities
                                                                 Deployment                      Effort
                                                                      Mode

                                                Content Re-Use

          © 2011 SAP AG. All rights reserved.                                                                              Confidential       23

ASAP 8 Supports variety of Deployment Project Strategies

                                                                                                                                           Go Live
     Design-Based                      Project Prep          Blueprint           Realization                               Final Prep
                                                                                                                                           Support
(Agile Approach Possible)                             Deploy

    Assemble to                                                               Agile Sprints                      Go Live
                                       Project Prep            Deploy                              Final Prep
                                                                              Realization                        Support
Order (A2O) Agile
                                           Start                                                                 Run

                                                                         Delta                                   Go Live
    Assemble to                        Project Prep         Deploy                 Realization**    Final Prep
                                                                         Scoping**                               Support
Order (A2O) Delta                          Start                                                                 Run
         Scoping

     Industrialized                    Start       Deploy      Run

                                          Engineered Effort                           Non-Engineered Effort                     Go Live

  ** Delta Scoping and Realization of gaps might be delivered outside the scope of the fixed price A2O project

 © 2011 SAP AG. All rights reserved.                                                                                             Confidential        24

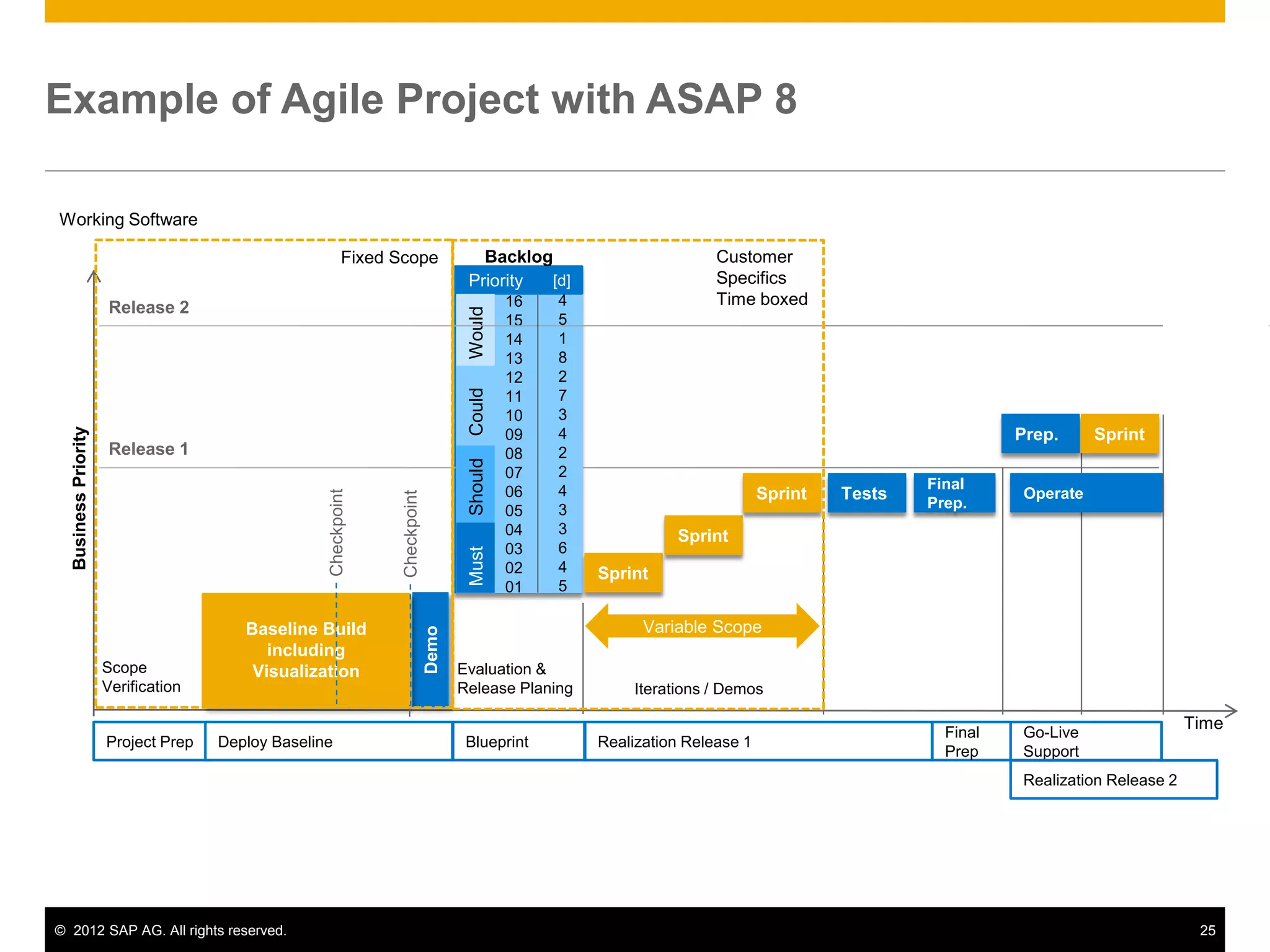

Example of Agile Project with ASAP 8

Working Software

                                                        Fixed Scope                   Backlog                        Customer
                                                                                    Priority [d]                     Specifics
                       Release 2                                                            16   4                   Time boxed

                                                                                   Would
                                                                                            15   5
                                                                                            14   1
                                                                                            13   8
                                                                                            12   2
                                                                                            11   7

                                                                                   Could
                                                                                            10   3
                                                                                            09   4
  Business Priority

                                                                                                                                                        Prep.      Sprint
                       Release 1                                                            08   2
                                                                                   Should   07   2
                                                                                                                                              Final
                                                                                            06   4                           Sprint   Tests              Operate
                                                  Checkpoint

                                                               Checkpoint

                                                                                            05   3                                            Prep.
                                                                                            04   3              Sprint
                                                                                            03   6
                                                                                   Must

                                                                                            02   4   Sprint
                                                                                            01   5

                                        Baseline Build                                                     Variable Scope
                                                                            Demo

                                           including
                      Scope              Visualization                             Evaluation &
                      Verification                                                 Release Planing        Iterations / Demos

                                                                                                                                                Final   Go-Live
                                                                                                                                                                                Time
                      Project Prep   Deploy Baseline                                Blueprint        Realization Release 1
                                                                                                                                                Prep    Support
                                                                                                                                                        Realization Release 2

© 2012 SAP AG. All rights reserved.                                                                                                                                              25
Example of Traditional Design-Based Project
with ASAP 8

                              Leveraging pre-configured                                                                             Operate
                         / pre-built content and services
                                                                                                                       Final
                                                                                                                       Prep.

                                                                                                               Tests

                                                                                                     C2
                                                                                                     config

                                                                                            C1
                                                                                            config
                                                   Checkpoint

                                                                                   BL
                                                                                   config

                                                                       Solution
                                                                       Blueprint

                              Prototype
                                                                Demo

                                  &
                             Visualization

                                                                                                                        Final   Go-Live
                                                                                                                                              Time
       Project Prep                           Blueprint                                          Realization
                                                                                                                        Prep    Support

© 2012 SAP AG. All rights reserved.                                                                                                            26
How to access ASAP 8 + Training
ASAP 8 is available on SAP Service Marketplace

  Top-level access to ASAP on SAP     Direct access to ASAP on SAP
  Service Marketplace                 Service Marketplace
  https://service.sap.com/asap        (Agile and Standard)

© 2012 SAP AG. All rights reserved.                                  28

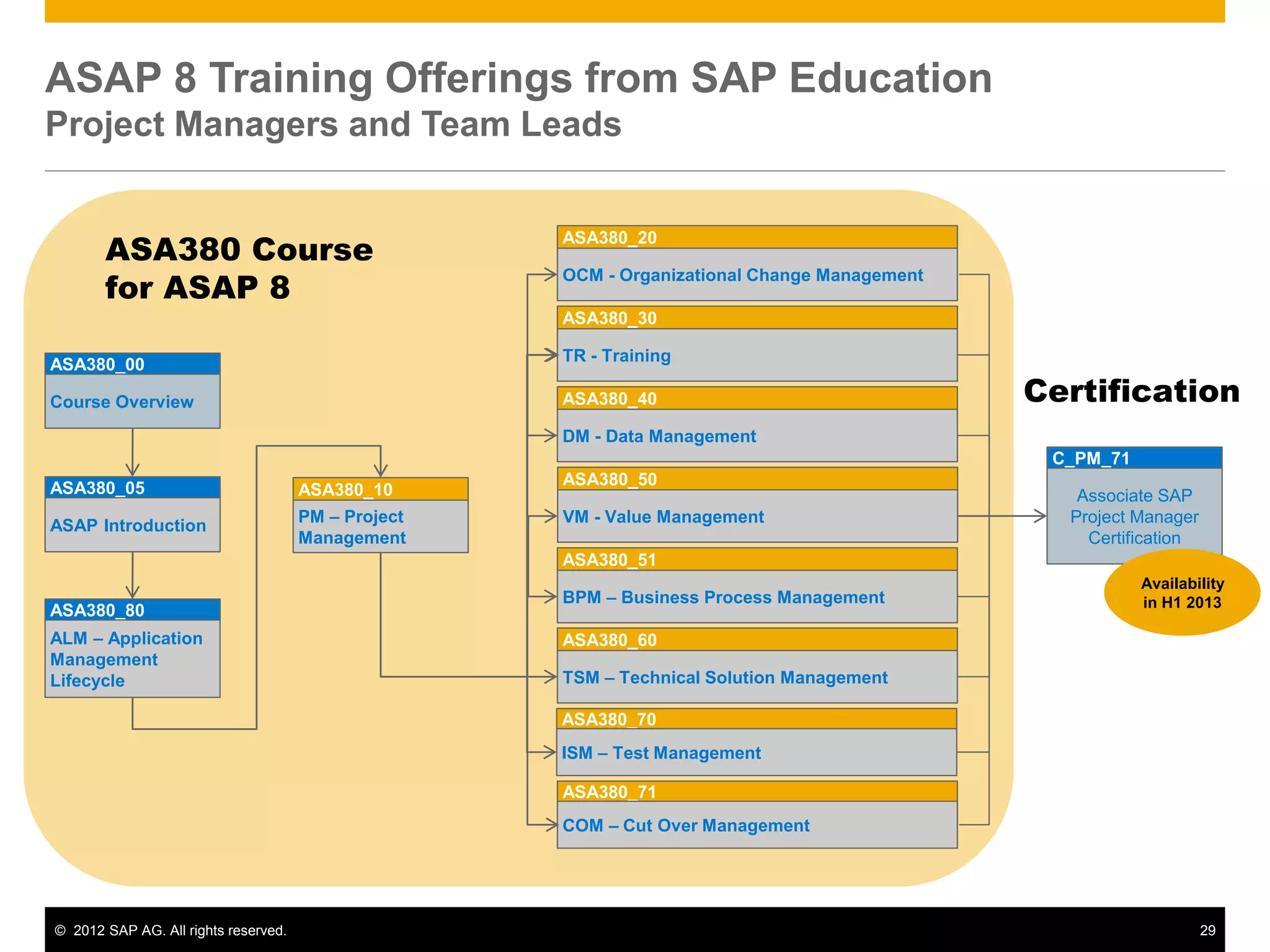

ASAP 8 Training Offerings from SAP Education
Project Managers and Team Leads

       ASA380 Course
                                                     ASA380_20

       for ASAP 8
                                                     OCM - Organizational Change Management

                                                     ASA380_30

                                                     TR - Training
ASA380_00

Course Overview                                      ASA380_40                                Certification
                                                     DM - Data Management
                                                                                               C_PM_71
ASA380_05                                            ASA380_50
                                      ASA380_10                                                  Associate SAP
ASAP Introduction
                                      PM – Project   VM - Value Management                      Project Manager
                                      Management                                                  Certification
                                                     ASA380_51
                                                                                                         Availability
                                                     BPM – Business Process Management                   in H1 2013
ASA380_80
ALM – Application                                    ASA380_60
Management
Lifecycle                                            TSM – Technical Solution Management

                                                     ASA380_70
                                                     ISM – Test Management

                                                     ASA380_71
                                                     COM – Cut Over Management

© 2012 SAP AG. All rights reserved.                                                                               29

ASAP 8 Recap
ASAP 8 Key Take Aways

        Delivery Methodology is fundamental corner stone
        for prescribing delivery model for services and projects

  ASAP 8 builds on foundation created in ASAP 7
  ASAP 8 is a Methodology supporting all four
   ADM delivery models
  Over 200 SAP Preconfigured Services based
   on ASAP 8 framework
  Methodology emphasizes incremental delivery of
   value, rapid deployment and visualization
   techniques
  Continued strong focus on project quality with
   formal Quality Gates (standard and RDS)
  Methodology defines prescriptive delivery
   approach for services and projects
  ASAP 8 is available now for use by project
   teams in SAP deployment projects

© 2012 SAP AG. All rights reserved.                                31
Call to Action

                                      Access to ASAP 8 on SAP Service
                                      Marketplace
                                      http://service.sap.com/asap

                                      Join ASAP Space in SAP Community
                                      Network
                                      http://scn.sap.com/community/asap-methodology

                                      Join SAP Advanced Delivery Management
                                      community
                                      SAP Advanced Delivery Management

                                      Ask Questions
                                      Post your questions to the ASAP Methodology
                                      discussions in SCN community

© 2012 SAP AG. All rights reserved.                                                   32
Thank You!

Press *1 to ask question. Or
type it in the chat window.

Jan Musil, Global Lead of SAP Project Management Practice
jan.musil@sap.com

ASAP 8.0 Methodology

  • 1.
    ASAP 8 Deep Diveinto Methodology Framework for SAP Projects and services Jan Musil, Global Lead of PM Practice - SAP Services
  • 2.
    Disclaimer This presentation outlinesour general product direction and should not be relied on in making a purchase decision. This presentation is not subject to your license agreement or any other agreement with SAP. SAP has no obligation to pursue any course of business outlined in this presentation or to develop or release any functionality mentioned in this presentation. This presentation and SAP's strategy and possible future developments are subject to change and may be changed by SAP at any time for any reason without notice. This document is provided without a warranty of any kind, either express or implied, including but not limited to, the implied warranties of merchantability, fitness for a particular purpose, or non-infringement. SAP assumes no responsibility for errors or omissions in this document, except if such damages were caused by SAP intentionally or grossly negligent. © 2012 SAP AG. All rights reserved. 2
  • 3.
    Your presenter Jan Musil, SAP America Global lead of SAP Project Management Practice © 2012 SAP AG. All rights reserved. 3
  • 4.
    Outline of whatwe will cover Purpose of the Presentation • Review SAP’s Advanced Delivery Management concept • Introduce ASAP 8 Methodology • Outline how SAP designs services with ASAP 8 • What’s new in ASAP 8 • How to access the methodology • Demo of ASAP 8 © 2012 SAP AG. All rights reserved. 4
  • 5.
    What is SAPAdvanced Delivery Management
  • 6.
    With New DeliveryApproach we … … ensure the most predictable and fastest time to business value … deliver the integration the business demands to start and grow without compromises … choose from a modular ready to use portfolio of solution, deployment and pricing options … innovate faster than competitors and leverage the full potential of the game changers © 2012 SAP AG. All rights reserved. 6
  • 7.
    The Big Idea– Apply Modular* Approach to Services RESULT any number of variants possible with minimal effort MODULARIZATION two configurable parts (modules) START four variants with high effort of creation * Source: Porsche Consulting, „Caracho“ 07, „Varianten Reichtum“ © 2012 SAP AG. All rights reserved. 7
  • 8.
    Saving Time andCosts with the Right Mix of Delivery Models 0 10 20 30 40 50 60 70 80 90 100 % time and effort Business Strategic Design Based Prep Realization Testing Go-live Blueprint Assemble to Order Industrialized Start Deploy Run Commodity Blueprint - up to 100% Savings Realization - up to 50% Savings Testing- up to 30% Savings  Fixed scope  Best Practices processes  Test Case templates supplied  Business Blueprint ready to configured and documented  Operations support templates validate  Delivery through transports available  Best Practice processes and BC Sets modeled and described  Operational Support Documents available © 2012 SAP AG. All rights reserved. 8
  • 9.
    The New ServicesPlaybook Customers and Partners Organization People Local Near-shore Off-shore Skills Enablement Adoption Service Portfolio Methodology Content Systems and Infrastructure © 2012 SAP AG. All rights reserved. 9
  • 10.
    Introducing ASAP 8Methodology
  • 11.
    ASAP 8 Methodology Oneintegrated framework for services and project delivery Delivery Methodology is fundamental corner stone for prescribing delivery model for services and delivery projects  Prescriptive and Comprehensive guided work procedures for project team, Delivery deliverables for project managers and accelerators for all users Location Models Content  Scalable From Industrialized Services through A2O to Design-based Projects  Innovative Agile, Design Thinking, Visualization, Cloud- based Deployment  Sound Practices Access ASAP 8 Project Quality Gates  Knowledge Capture and Re-use © 2012 SAP AG. All rights reserved. 11
  • 12.
    ASAP 8 andSAP Advanced Delivery Management provide Full Lifecycle Support Project Business Final Go Live Discovery Realization Operate Preparation Blueprint Preparation Support Prescriptive Delivery Approach Process Application Project Value Lifecycle Lifecycle Lifecycle Lifecycle Implementation Project standards BPM Method Methodology (PMI PMBOK) Value Management BPM Technology ALM System PM Tools Value Mgmt. Tools Business Unit Process Owner CIO Project Manager Owner © 2012 SAP AG. All rights reserved. 12
  • 13.
    ASAP 8: IncrementalDelivery with Assembled to Order Illustrative Use Case for Multiple RDSs Release 1 – Core HCM Release 2 – EMSS + Reporting Discovery HCM RDS Employee and Manager Self Service RDS HCM Localization RDS SAP Executive HR Reporting Interfaces Expert Services Understand Deliver value early, Enhance the solution business needs build a baseline in iterations SAP Services Catalog Value / Expert Services Engineered Services © 2011 SAP AG. All rights reserved. Confidential 13
  • 14.
    Release 1: CoreHCM RDS + Localization + Interfaces Example with 25 Weeks Implementation Release 2 Continuous oversight is recommended (Optional) Additional Scope Go-Live Checkpoint Checkpoint Checkpoint Checkpoint Release 1 Checkpoint Checkpoint Support Localize Cloud APJ ECC6 EP5 Localize Europe Checkpoint Localize Mexico Final Prep. Integration Tests Interface Development Validation HCM RDS RDS HCM RDS US RDS US Testing Time Start Deploy Run 3 week 6 weeks 2 weeks 8 weeks 2 weeks 1 wk 1 wk 2 weeks © 2011 SAP AG. All rights reserved. Confidential 14
  • 15.
    ASAP Work BreakdownStructure – standardization with lean approach ASAP V3.10 – Streamlined Standardized release 2009 WBS ASAP 7.x WBS ASAP 8 Phase Phase Phase Deliverable group Work stream Deliverable Deliverable Deliverable Task Sub-deliverable Attributes assigned to: Sub-deliverable (optional) • Deliverables Activity • Tasks Task Output Design-based projects only All ADM delivery models © 2011 SAP AG. All rights reserved. Confidential 15
  • 16.
    ASAP 8 inSAP Service Marketplace - Demo © 2011 SAP AG. All rights reserved. Confidential 16
  • 17.
    Overview of ServiceDesign with ASAP 8
  • 18.
    ASAP 8 WBSis used in Service Design  All new services (including RDS) contain delivery WBS based on ASAP 8 framework  Over 200 services mapped to the ASAP 8 WBS framework  Each service leverages standard ASAP tasks, delivery mode, deployment mode  Resulting in higher consistency and re-use of standard prescriptive methodology  Ability to combine services into Assemble to Order projects © 2012 SAP AG. All rights reserved. 18
  • 19.
    What’s New inASAP 8 Key Improvements
  • 20.
    Overview of enhancementsin ASAP 8  ASAP WBS streamlined to 3 levels with prescriptive delivery attributes (accountability, delivery mode, etc.).  ASAP 8 became framework for different deployment strategies – RDS, A2O, Traditional, Agile.  Improvements in Quality Gate concept and templates (RDS + Traditional)  Agile, iRise and Design Thinking guidance built into ASAP  Operate phase aligned to Application Lifecycle Management processes  Work Stream structure refined  New and Updated Accelerators © 2012 SAP AG. All rights reserved. 20
  • 21.
    Example: ASAP 7.x ASAP 8 Work Streams ASAP 8 ASAP 7.x Project Management - PM Project Management Organizational Change Management - OCM Organizational Change Training - TRN Management Data Migration - DM Training Data Archiving - DA Data Management Value Management - VM Business Process Business Process Management - BPM Management Technical Solution Technical Solution Management - TSM Management Application Lifecycle Management - ALM Integrated Solution Management Test Management - ISM Cutover Management - COM © 2012 SAP AG. All rights reserved. 21
  • 22.
    ASAP 8 inSAP Delivery Projects
  • 23.
    How we Deliver Clear Work Breakdown and Assignment Discovery Deliver Services Initiate Plan Execute Monitor & Close Project Project Project Control Project Project Services in a Project WBS Service Portfolio ASAP8 Iterative Customer Needs Deployment Solution Demos Visualizations Deliverable / Roles Task Responsibilities Deployment Effort Mode Content Re-Use © 2011 SAP AG. All rights reserved. Confidential 23
  • 24.
    ASAP 8 Supportsvariety of Deployment Project Strategies Go Live Design-Based Project Prep Blueprint Realization Final Prep Support (Agile Approach Possible) Deploy Assemble to Agile Sprints Go Live Project Prep Deploy Final Prep Realization Support Order (A2O) Agile Start Run Delta Go Live Assemble to Project Prep Deploy Realization** Final Prep Scoping** Support Order (A2O) Delta Start Run Scoping Industrialized Start Deploy Run Engineered Effort Non-Engineered Effort Go Live ** Delta Scoping and Realization of gaps might be delivered outside the scope of the fixed price A2O project © 2011 SAP AG. All rights reserved. Confidential 24
  • 25.
    Example of AgileProject with ASAP 8 Working Software Fixed Scope Backlog Customer Priority [d] Specifics Release 2 16 4 Time boxed Would 15 5 14 1 13 8 12 2 11 7 Could 10 3 09 4 Business Priority Prep. Sprint Release 1 08 2 Should 07 2 Final 06 4 Sprint Tests Operate Checkpoint Checkpoint 05 3 Prep. 04 3 Sprint 03 6 Must 02 4 Sprint 01 5 Baseline Build Variable Scope Demo including Scope Visualization Evaluation & Verification Release Planing Iterations / Demos Final Go-Live Time Project Prep Deploy Baseline Blueprint Realization Release 1 Prep Support Realization Release 2 © 2012 SAP AG. All rights reserved. 25
  • 26.
    Example of TraditionalDesign-Based Project with ASAP 8 Leveraging pre-configured Operate / pre-built content and services Final Prep. Tests C2 config C1 config Checkpoint BL config Solution Blueprint Prototype Demo & Visualization Final Go-Live Time Project Prep Blueprint Realization Prep Support © 2012 SAP AG. All rights reserved. 26
  • 27.
    How to accessASAP 8 + Training
  • 28.
    ASAP 8 isavailable on SAP Service Marketplace Top-level access to ASAP on SAP Direct access to ASAP on SAP Service Marketplace Service Marketplace https://service.sap.com/asap (Agile and Standard) © 2012 SAP AG. All rights reserved. 28
  • 29.
    ASAP 8 TrainingOfferings from SAP Education Project Managers and Team Leads ASA380 Course ASA380_20 for ASAP 8 OCM - Organizational Change Management ASA380_30 TR - Training ASA380_00 Course Overview ASA380_40 Certification DM - Data Management C_PM_71 ASA380_05 ASA380_50 ASA380_10 Associate SAP ASAP Introduction PM – Project VM - Value Management Project Manager Management Certification ASA380_51 Availability BPM – Business Process Management in H1 2013 ASA380_80 ALM – Application ASA380_60 Management Lifecycle TSM – Technical Solution Management ASA380_70 ISM – Test Management ASA380_71 COM – Cut Over Management © 2012 SAP AG. All rights reserved. 29
  • 30.
  • 31.
    ASAP 8 KeyTake Aways Delivery Methodology is fundamental corner stone for prescribing delivery model for services and projects  ASAP 8 builds on foundation created in ASAP 7  ASAP 8 is a Methodology supporting all four ADM delivery models  Over 200 SAP Preconfigured Services based on ASAP 8 framework  Methodology emphasizes incremental delivery of value, rapid deployment and visualization techniques  Continued strong focus on project quality with formal Quality Gates (standard and RDS)  Methodology defines prescriptive delivery approach for services and projects  ASAP 8 is available now for use by project teams in SAP deployment projects © 2012 SAP AG. All rights reserved. 31
  • 32.
    Call to Action Access to ASAP 8 on SAP Service Marketplace http://service.sap.com/asap Join ASAP Space in SAP Community Network http://scn.sap.com/community/asap-methodology Join SAP Advanced Delivery Management community SAP Advanced Delivery Management Ask Questions Post your questions to the ASAP Methodology discussions in SCN community © 2012 SAP AG. All rights reserved. 32
  • 33.
    Thank You! Press *1to ask question. Or type it in the chat window. Jan Musil, Global Lead of SAP Project Management Practice jan.musil@sap.com
