By the power of metrics
LeanKanban Central Europe 2014 - #LKCE14
Wolfgang Wiedenroth @wwiedenroth

Metrics in the Kanban Method
Practices
1.Visualize
2.Limit WIP
3.Manage Flow
4.Make Process Policies Explicit
5.Develop Feedback Loops
6.Improve Collaboratively, Evolve Experimentally
(using models/scientific method)

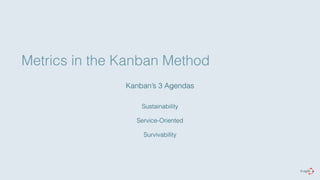

Metrics in the Kanban Method

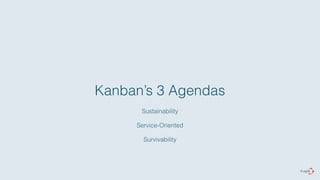

Kanban’s 3 Agendas
Sustainability
Service-Oriented
Survivability
Metrics in the Kanban Method
Practices
1.Visualize
2.Limit WIP
3.Manage Flow
4.Make Process Policies Explicit
5.Develop Feedback Loops
6.Improve Collaboratively, Evolve Experimentally
(using models/scientific method)
Kanban’s 3 Agendas
Sustainability
Service-Oriented
Survivability
115#
110#
105#
100#
95#
90#
85#
80#
75#
70#
65#
60#
55#
50#
45#
40#
35#
30#
25#
20#
1#May#2012#
11#May#2012#
7#May#2012#
17#May#2012#
23#May#2012#
29#May#2012#
4#Jun#2012#
14#Jun#2012#
8#Jun#2012#
20#Jun#2012#
26#Jun#2012#
2#Jul#2012#
6#Jul#2012#
12#Jul#2012#
Departure Rate
24#Jul#2012#
18#Jul#2012#
30#Jul#2012#
3#Aug#2012#
Work piling up
15#Aug#2012#
9#Aug#2012#
21#Aug#2012#
27#Aug#2012#
31#Aug#2012#
6#Sep#2012#
12#Sep#2012#
24#Sep#2012#
18#Sep#2012#
28#Sep#2012#
10#Oct#2012#
4#Oct#2012#
16#Oct#2012#
22#Oct#2012#
26#Oct#2012#
1#Nov#2012#
13#Nov#2012#
7#Nov#2012#
19#Nov#2012#
23#Nov#2012#
29#Nov#2012#
5#Dec#2012#
11#Dec#2012#
21#Dec#2012#
17#Dec#2012#
2#Jan#2013#
27#Dec#2012#
8#Jan#2013#
14#Jan#2013#
24#Jan#2013#
18#Jan#2013#
Analyse# Selected# Planning# Planning#Done# Dev# Dev#Done# TesDng# TesDng#Done/Endgame# to#be#released# Released#

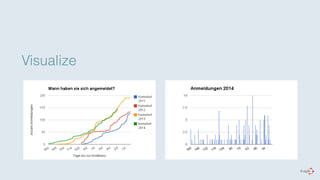

Visualize

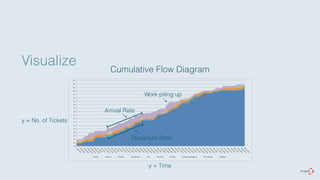

Cumulative Flow Diagram
y = No. of Tickets
y = Time
Arrival Rate
Visualize

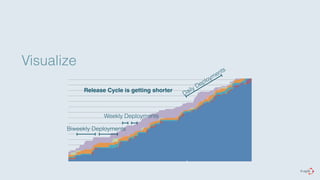

Release Cycle is getting shorter
Daily Deployments
Weekly Deployments
Biweekly Deployments
Visualize

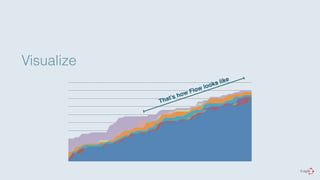

That’s how Flow looks like

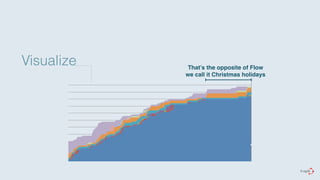

Visualize That’s the opposite of Flow!
we call it Christmas holidays
Visualize
20"
19"
18"
17"
16"
15"
14"
13"
12"
11"
10"
9"
8"
7"
6"
5"
4"
3"
2"
1"
0"

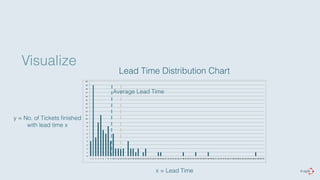

Lead Time Distribution Chart
Average Lead Time
1" 2" 3" 4" 5" 6" 7" 8" 9" 10"11"12"13"14"15"16"17"18"19"20"21"22"23"24"25"26"27"28"29"30"31"32"33"34"35"36"37"38"39"40"41"42"43"44"45"46"47"48"49"50"51"52"53"54"55"56"57"58"59"60"61"62"63"64"65"66"67"68"69"70"
y = No. of Tickets finished
with lead time x
x = Lead Time
6"
5"
4"
3"
2"
1"
0"
MEDIAN"
6" 7" 8" 9" 10" 11" 12" 13" 14" 15" 16" 17" 18" 19" 20" 21" 22" 23" 24" 25" 26" 27" 28" 29" 30" 31" 32" 33" 34" 35" 36" 37" 38" 39" 40" 41" 42" 43" 44" 45" 46" 47" 48" 49" 50" 51" 52" 1" 2" 3" 4" 5" 6" 7" 8" 9"
Visualize

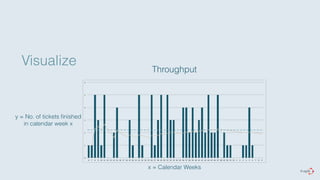

Throughput
x = Calendar Weeks
y = No. of tickets finished
in calendar week x
Visualize
Visualized metrics let you
see things faster
Visualized metrics let you
identify pattern
Visualized metrics give
everyone the same picture
Visualized metrics are
great feedback loops
Manage Flow
Manage Flow
Demand
Capability

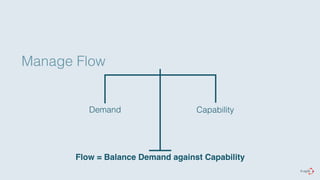

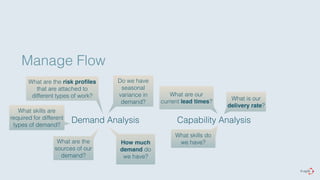

Manage Flow

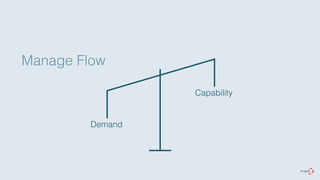

Demand Capability
Flow = Balance Demand against Capability
Manage Flow
Demand Analysis Capability Analysis
How much
demand do
we have?
What are the
sources of our
demand?
Do we have
seasonal
variance in
demand?
What are the risk profiles
that are attached to
different types of work?
What skills are
required for different
types of demand?
What are our
current lead times?
What is our
delivery rate?
What skills do
we have?

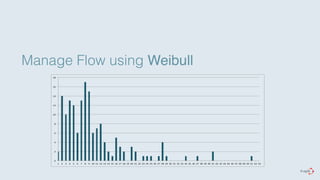

Manage Flow using Weibull
18"
16"
14"
12"
10"
8"
6"
4"
2"
0"
1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15" 16" 17" 18" 19" 20" 21" 22" 23" 24" 25" 26" 27" 28" 29" 30" 31" 32" 33" 34" 35" 36" 37" 38" 39" 40" 41" 42" 43" 44" 45" 46" 47" 48" 49" 50" 51" 52" 53"

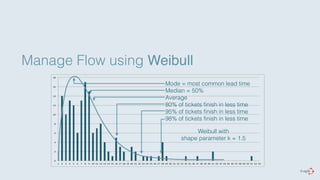

Manage Flow using Weibull
18"
16"
14"
12"
10"
8"
6"
4"
2"
0"
Mode = most common lead time
Median = 50%
Average
80% of tickets finish in less time
95% of tickets finish in less time
98% of tickets finish in less time
Weibull with
shape parameter k = 1.5
1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15" 16" 17" 18" 19" 20" 21" 22" 23" 24" 25" 26" 27" 28" 29" 30" 31" 32" 33" 34" 35" 36" 37" 38" 39" 40" 41" 42" 43" 44" 45" 46" 47" 48" 49" 50" 51" 52" 53"
Manage Flow using Weibull
18"
16"
14"
12"
10"
8"
6"
4"
2"
0"
1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15" 16" 17" 18" 19" 20" 21" 22" 23" 24" 25" 26" 27" 28" 29" 30" 31" 32" 33" 34" 35" 36" 37" 38" 39" 40" 41" 42" 43" 44" 45" 46" 47" 48" 49" 50" 51" 52" 53"

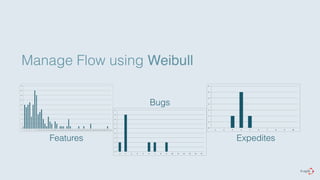

4"
3"
3"
2"
2"
1"
1"
0"
1" 2" 3" 4" 5" 6" 7" 8" 9" 10"
5"
4"
4"
3"
3"
2"
2"
1"
1"
0"
1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15"
Features
Bugs
Expedites
Manage Flow using Weibull
18"
16"
14"
12"
10"
8"
6"
4"
2"
0"
Features Q(p;k, λ) = λ( - ln(1 - p))1/k
1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15" 16" 17" 18" 19" 20" 21" 22" 23" 24" 25" 26" 27" 28" 29" 30" 31" 32" 33" 34" 35" 36" 37" 38" 39" 40" 41" 42" 43" 44" 45" 46" 47" 48" 49" 50" 51" 52" 53"

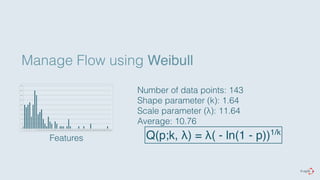

Number of data points: 143
Shape parameter (k): 1.64
Scale parameter (λ): 11.64
Average: 10.76
Manage Flow using Weibull
18"
16"
14"
12"
10"
8"
6"
4"
2"
0"

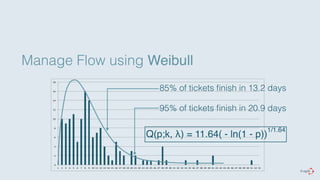

85% of tickets finish in 13.2 days
95% of tickets finish in 20.9 days
Q(p;k, λ) = 11.64( - ln(1 - p))1/1.64
1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15" 16" 17" 18" 19" 20" 21" 22" 23" 24" 25" 26" 27" 28" 29" 30" 31" 32" 33" 34" 35" 36" 37" 38" 39" 40" 41" 42" 43" 44" 45" 46" 47" 48" 49" 50" 51" 52" 53"
Manage Flow using Weibull
5"
4"
4"
3"
3"
2"
2"
1"
1"
0"
1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15"
Bugs

Number of data points: 8
Shape parameter:
Scale parameter:
Average: 3.88
not enough data points,

but visualisation gives us
an idea of the shape
Manage Flow using Weibull
5"
4"
4"
3"
3"
2"
2"
1"
1"
0"
1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15"
Bugs
Number of data points: 8
Shape parameter: looks like between 1.25 and 1.50
Scale parameter:
Average: 3.88
Manage Flow using Weibull and Forecasting Cards
k = 0.75
k = 1.25
k = 1.50

Manage Flow using Weibull and Forecasting Cards
Alexei Zheglov
Manage Flow using Weibull and Forecasting Cards

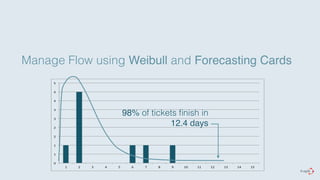

5"
4"
4"
3"
3"
2"
2"
1"
1"
0"
98% of tickets finish in
12.4 days
1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15"
Manage Flow using Weibull

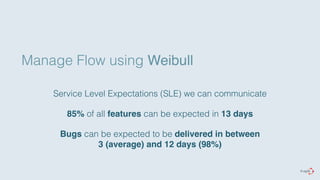

Service Level Expectations (SLE) we can communicate
85% of all features can be expected in 13 days
Bugs can be expected to be delivered in between
3 (average) and 12 days (98%)
Manage Project Flow

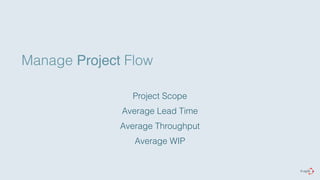

Project Scope
Average Lead Time
Average Throughput
Average WIP

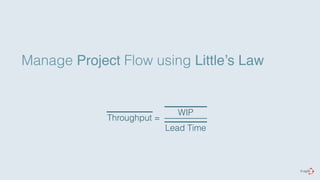

Manage Project Flow using Little’s Law
WIP
Lead Time
Throughput =
Manage Project Flow using Little’s Law

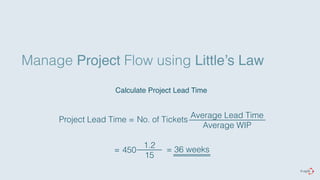

Calculate Project Lead Time
Project Lead Time = No. of Tickets
Average Lead Time
Average WIP
= 450
1.2
15
= 36 weeks
Manage Project Flow using Little’s Law
Calculate Project Budget
Average WIP = Average Lead Time
No. of Tickets
Delivery date in weeks
= 1.2
450
36
= 15 WIP
Manage Project Flow using Little’s Law

Project Scope
20% 60% 20%
End Date
2nd leg
1st leg
3rd leg
Delivery Rate
Metrics help you
to better understand your
demand and capability
Metrics help you
calculate Service Level Expectations (SLE)
for different work items
Metrics help you
forecast your projects#
without estimating
Metrics to secure survival
Kanban’s 3 Agendas
Sustainability
Service-Oriented
Survivability

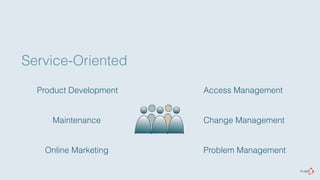

Service-Oriented
Product Development
Maintenance
Online Marketing
Access Management
Change Management
Problem Management
Survivability

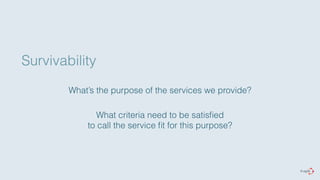

What’s the purpose of the services we provide?
What criteria need to be satisfied
to call the service fit for this purpose?

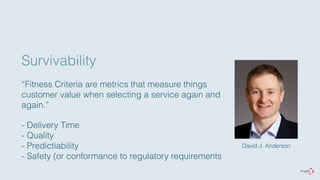

Survivability

“Fitness Criteria are metrics that measure things
customer value when selecting a service again and
again.”
- Delivery Time
- Quality
- Predictiability
- Safety (or conformance to regulatory requirements
David J. Anderson
Survivability

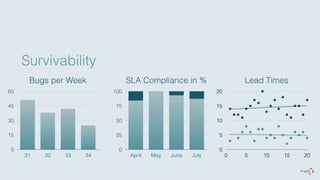

Bugs per Week
60
45
30
15
0
31 32 33 34
SLA Compliance in %
100
75
50
25
0
April May June July
Lead Times
20
15
10
5
0
0 5 10 15 20

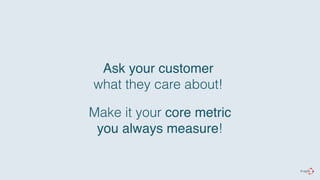

Ask your customer
what they care about!
Make it your core metric#
you always measure!
Metrics supporting changes
Metrics help us to distinct
between good and bad
changes from an objective
point of view
Metrics for improvements
Emotions
Risk
Measuring

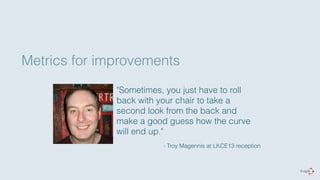

Metrics for improvements
"Sometimes, you just have to roll
back with your chair to take a
second look from the back and
make a good guess how the curve
will end up."
- Troy Magennis at LKCE13 reception

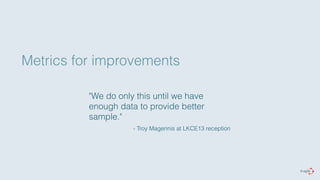

Metrics for improvements
"We do only this until we have
enough data to provide better
sample."
- Troy Magennis at LKCE13 reception
Always support
change with
measurements!

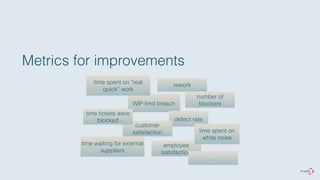

Metrics for improvements
WIP limit breach
defect rate
customer
satisfaction
employee
satisfaction
number of
blockers
time spent on “real
quick” work
time tickets were
blocked
time waiting for external
suppliers
rework
time spent on
white noise
…
Not like that! Keep it simple!
Bob from Operations
Wanted Y
Took me 60min
#
Urheber Markus Beyer - Herzlichen Dank!
Joe from Marketing
Wanted Y
Took me 30min
Sue from Product
Wanted Y
Took me 15min
CEO
Wanted Y
Took me 6h
Joe from Marketing
Wanted Y
Took me 45min
Regularly check your metrics, whether

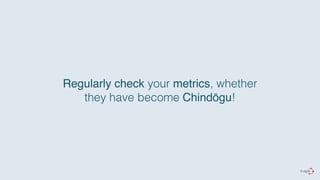

they have become Chindōgu!
chindōgu are sometimes described
as "unuseless" – that is, they
cannot be regarded as "useless" in
an absolute sense, since they do
actually solve a problem; however,
in practical terms, they cannot
positively be called "useful".
https://en.wikipedia.org/wiki/Chind%C5%8Dgu

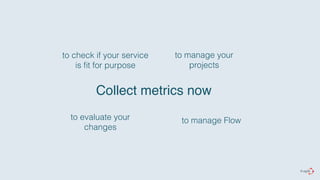

to check if your service
is fit for purpose
Metrics help you
to evaluate your
changes
to manage your
projects
to manage Flow
to check if your service
is fit for purpose
Collect metrics now
to evaluate your
changes
to manage your
projects
to manage Flow
Thank you!
Wolfgang Wiedenroth
Mail: wolfgang.wiedenroth@it-agile.de
Twitter: @wwiedenroth

By the power of metrics

  • 1.
    By the powerof metrics LeanKanban Central Europe 2014 - #LKCE14 Wolfgang Wiedenroth @wwiedenroth
  • 2.
    Metrics in theKanban Method Practices 1.Visualize 2.Limit WIP 3.Manage Flow 4.Make Process Policies Explicit 5.Develop Feedback Loops 6.Improve Collaboratively, Evolve Experimentally (using models/scientific method)
  • 3.
    Metrics in theKanban Method Kanban’s 3 Agendas Sustainability Service-Oriented Survivability
  • 4.
    Metrics in theKanban Method Practices 1.Visualize 2.Limit WIP 3.Manage Flow 4.Make Process Policies Explicit 5.Develop Feedback Loops 6.Improve Collaboratively, Evolve Experimentally (using models/scientific method) Kanban’s 3 Agendas Sustainability Service-Oriented Survivability
  • 5.
    115# 110# 105# 100# 95# 90# 85# 80# 75# 70# 65# 60# 55# 50# 45# 40# 35# 30# 25# 20# 1#May#2012# 11#May#2012# 7#May#2012# 17#May#2012# 23#May#2012# 29#May#2012# 4#Jun#2012# 14#Jun#2012# 8#Jun#2012# 20#Jun#2012# 26#Jun#2012# 2#Jul#2012# 6#Jul#2012# 12#Jul#2012# Departure Rate 24#Jul#2012# 18#Jul#2012# 30#Jul#2012# 3#Aug#2012# Work piling up 15#Aug#2012# 9#Aug#2012# 21#Aug#2012# 27#Aug#2012# 31#Aug#2012# 6#Sep#2012# 12#Sep#2012# 24#Sep#2012# 18#Sep#2012# 28#Sep#2012# 10#Oct#2012# 4#Oct#2012# 16#Oct#2012# 22#Oct#2012# 26#Oct#2012# 1#Nov#2012# 13#Nov#2012# 7#Nov#2012# 19#Nov#2012# 23#Nov#2012# 29#Nov#2012# 5#Dec#2012# 11#Dec#2012# 21#Dec#2012# 17#Dec#2012# 2#Jan#2013# 27#Dec#2012# 8#Jan#2013# 14#Jan#2013# 24#Jan#2013# 18#Jan#2013# Analyse# Selected# Planning# Planning#Done# Dev# Dev#Done# TesDng# TesDng#Done/Endgame# to#be#released# Released# Visualize Cumulative Flow Diagram y = No. of Tickets y = Time Arrival Rate
  • 6.
    Visualize Release Cycleis getting shorter Daily Deployments Weekly Deployments Biweekly Deployments
  • 7.
    Visualize That’s howFlow looks like
  • 8.
    Visualize That’s theopposite of Flow! we call it Christmas holidays
  • 9.
    Visualize 20" 19" 18" 17" 16" 15" 14" 13" 12" 11" 10" 9" 8" 7" 6" 5" 4" 3" 2" 1" 0" Lead Time Distribution Chart Average Lead Time 1" 2" 3" 4" 5" 6" 7" 8" 9" 10"11"12"13"14"15"16"17"18"19"20"21"22"23"24"25"26"27"28"29"30"31"32"33"34"35"36"37"38"39"40"41"42"43"44"45"46"47"48"49"50"51"52"53"54"55"56"57"58"59"60"61"62"63"64"65"66"67"68"69"70" y = No. of Tickets finished with lead time x x = Lead Time
  • 10.
    6" 5" 4" 3" 2" 1" 0" MEDIAN" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15" 16" 17" 18" 19" 20" 21" 22" 23" 24" 25" 26" 27" 28" 29" 30" 31" 32" 33" 34" 35" 36" 37" 38" 39" 40" 41" 42" 43" 44" 45" 46" 47" 48" 49" 50" 51" 52" 1" 2" 3" 4" 5" 6" 7" 8" 9" Visualize Throughput x = Calendar Weeks y = No. of tickets finished in calendar week x
  • 11.
  • 12.
    Visualized metrics letyou see things faster
  • 13.
    Visualized metrics letyou identify pattern
  • 14.
    Visualized metrics give everyone the same picture
  • 15.
    Visualized metrics are great feedback loops
  • 16.
  • 17.
    Manage Flow Demand Capability
  • 18.
    Manage Flow DemandCapability Flow = Balance Demand against Capability
  • 19.
    Manage Flow DemandAnalysis Capability Analysis How much demand do we have? What are the sources of our demand? Do we have seasonal variance in demand? What are the risk profiles that are attached to different types of work? What skills are required for different types of demand? What are our current lead times? What is our delivery rate? What skills do we have?
  • 20.
    Manage Flow usingWeibull 18" 16" 14" 12" 10" 8" 6" 4" 2" 0" 1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15" 16" 17" 18" 19" 20" 21" 22" 23" 24" 25" 26" 27" 28" 29" 30" 31" 32" 33" 34" 35" 36" 37" 38" 39" 40" 41" 42" 43" 44" 45" 46" 47" 48" 49" 50" 51" 52" 53"
  • 21.
    Manage Flow usingWeibull 18" 16" 14" 12" 10" 8" 6" 4" 2" 0" Mode = most common lead time Median = 50% Average 80% of tickets finish in less time 95% of tickets finish in less time 98% of tickets finish in less time Weibull with shape parameter k = 1.5 1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15" 16" 17" 18" 19" 20" 21" 22" 23" 24" 25" 26" 27" 28" 29" 30" 31" 32" 33" 34" 35" 36" 37" 38" 39" 40" 41" 42" 43" 44" 45" 46" 47" 48" 49" 50" 51" 52" 53"
  • 22.
    Manage Flow usingWeibull 18" 16" 14" 12" 10" 8" 6" 4" 2" 0" 1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15" 16" 17" 18" 19" 20" 21" 22" 23" 24" 25" 26" 27" 28" 29" 30" 31" 32" 33" 34" 35" 36" 37" 38" 39" 40" 41" 42" 43" 44" 45" 46" 47" 48" 49" 50" 51" 52" 53" 4" 3" 3" 2" 2" 1" 1" 0" 1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 5" 4" 4" 3" 3" 2" 2" 1" 1" 0" 1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15" Features Bugs Expedites
  • 23.
    Manage Flow usingWeibull 18" 16" 14" 12" 10" 8" 6" 4" 2" 0" Features Q(p;k, λ) = λ( - ln(1 - p))1/k 1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15" 16" 17" 18" 19" 20" 21" 22" 23" 24" 25" 26" 27" 28" 29" 30" 31" 32" 33" 34" 35" 36" 37" 38" 39" 40" 41" 42" 43" 44" 45" 46" 47" 48" 49" 50" 51" 52" 53" Number of data points: 143 Shape parameter (k): 1.64 Scale parameter (λ): 11.64 Average: 10.76
  • 24.
    Manage Flow usingWeibull 18" 16" 14" 12" 10" 8" 6" 4" 2" 0" 85% of tickets finish in 13.2 days 95% of tickets finish in 20.9 days Q(p;k, λ) = 11.64( - ln(1 - p))1/1.64 1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15" 16" 17" 18" 19" 20" 21" 22" 23" 24" 25" 26" 27" 28" 29" 30" 31" 32" 33" 34" 35" 36" 37" 38" 39" 40" 41" 42" 43" 44" 45" 46" 47" 48" 49" 50" 51" 52" 53"
  • 25.
    Manage Flow usingWeibull 5" 4" 4" 3" 3" 2" 2" 1" 1" 0" 1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15" Bugs Number of data points: 8 Shape parameter: Scale parameter: Average: 3.88 not enough data points, but visualisation gives us an idea of the shape
  • 26.
    Manage Flow usingWeibull 5" 4" 4" 3" 3" 2" 2" 1" 1" 0" 1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15" Bugs Number of data points: 8 Shape parameter: looks like between 1.25 and 1.50 Scale parameter: Average: 3.88
  • 27.
    Manage Flow usingWeibull and Forecasting Cards k = 0.75 k = 1.25 k = 1.50
  • 28.
    Manage Flow usingWeibull and Forecasting Cards Alexei Zheglov
  • 29.
    Manage Flow usingWeibull and Forecasting Cards 5" 4" 4" 3" 3" 2" 2" 1" 1" 0" 98% of tickets finish in 12.4 days 1" 2" 3" 4" 5" 6" 7" 8" 9" 10" 11" 12" 13" 14" 15"
  • 30.
    Manage Flow usingWeibull Service Level Expectations (SLE) we can communicate 85% of all features can be expected in 13 days Bugs can be expected to be delivered in between 3 (average) and 12 days (98%)
  • 31.
    Manage Project Flow Project Scope Average Lead Time Average Throughput Average WIP
  • 32.
    Manage Project Flowusing Little’s Law WIP Lead Time Throughput =
  • 33.
    Manage Project Flowusing Little’s Law Calculate Project Lead Time Project Lead Time = No. of Tickets Average Lead Time Average WIP = 450 1.2 15 = 36 weeks
  • 34.
    Manage Project Flowusing Little’s Law Calculate Project Budget Average WIP = Average Lead Time No. of Tickets Delivery date in weeks = 1.2 450 36 = 15 WIP
  • 35.
    Manage Project Flowusing Little’s Law Project Scope 20% 60% 20% End Date 2nd leg 1st leg 3rd leg Delivery Rate
  • 36.
    Metrics help you to better understand your demand and capability
  • 37.
    Metrics help you calculate Service Level Expectations (SLE) for different work items
  • 38.
    Metrics help you forecast your projects# without estimating
  • 39.
  • 40.
    Kanban’s 3 Agendas Sustainability Service-Oriented Survivability
  • 41.
    Service-Oriented Product Development Maintenance Online Marketing Access Management Change Management Problem Management
  • 42.
    Survivability What’s thepurpose of the services we provide? What criteria need to be satisfied to call the service fit for this purpose?
  • 43.
    Survivability “Fitness Criteriaare metrics that measure things customer value when selecting a service again and again.” - Delivery Time - Quality - Predictiability - Safety (or conformance to regulatory requirements David J. Anderson
  • 44.
    Survivability Bugs perWeek 60 45 30 15 0 31 32 33 34 SLA Compliance in % 100 75 50 25 0 April May June July Lead Times 20 15 10 5 0 0 5 10 15 20
  • 45.
    Ask your customer what they care about! Make it your core metric# you always measure!
  • 46.
  • 50.
    Metrics help usto distinct between good and bad changes from an objective point of view
  • 51.
    Metrics for improvements Emotions Risk Measuring
  • 52.
    Metrics for improvements "Sometimes, you just have to roll back with your chair to take a second look from the back and make a good guess how the curve will end up." - Troy Magennis at LKCE13 reception
  • 53.
    Metrics for improvements "We do only this until we have enough data to provide better sample." - Troy Magennis at LKCE13 reception
  • 54.
    Always support changewith measurements!
  • 55.
    Metrics for improvements WIP limit breach defect rate customer satisfaction employee satisfaction number of blockers time spent on “real quick” work time tickets were blocked time waiting for external suppliers rework time spent on white noise …
  • 56.
    Not like that!Keep it simple!
  • 57.
    Bob from Operations Wanted Y Took me 60min # Urheber Markus Beyer - Herzlichen Dank! Joe from Marketing Wanted Y Took me 30min Sue from Product Wanted Y Took me 15min CEO Wanted Y Took me 6h Joe from Marketing Wanted Y Took me 45min
  • 58.
    Regularly check yourmetrics, whether they have become Chindōgu!
  • 59.
    chindōgu are sometimesdescribed as "unuseless" – that is, they cannot be regarded as "useless" in an absolute sense, since they do actually solve a problem; however, in practical terms, they cannot positively be called "useful". https://en.wikipedia.org/wiki/Chind%C5%8Dgu
  • 60.
    to check ifyour service is fit for purpose Metrics help you to evaluate your changes to manage your projects to manage Flow
  • 61.
    to check ifyour service is fit for purpose Collect metrics now to evaluate your changes to manage your projects to manage Flow
  • 62.
    Thank you! WolfgangWiedenroth Mail: wolfgang.wiedenroth@it-agile.de Twitter: @wwiedenroth
