Bid EvaluationBid EvaluationEng. V.Mohan./
Project Director-
CENTRAL EXPRESSWAY PROJECT-II,
M.Sc(PPM, Turin, Italy), Dip.In Com.Com. Arb (ICLP),DIPPCA (SL), FCIHT(Lond), FIE(SL), B.Sc(Eng),MIE (SL)
ROAD DEVELOPMENT AUTHORITY
3rd Floor, "Sethsiripaya ", Battaramulla, CO 10120, Sri Lanka,
Office :-+94112877708 - Extension -126
Mobile: +94-77 316 8726, +94 71 843 3070 Home ;+94112322070 Fax No.+94112877708
Email: nsvmohan@gmail.com

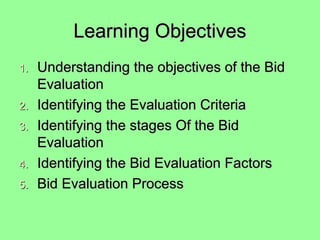

Learning ObjectivesLearning Objectives
1.1. Understanding the objectives of the BidUnderstanding the objectives of the Bid
EvaluationEvaluation
2.2. Identifying the Evaluation CriteriaIdentifying the Evaluation Criteria
3.3. Identifying the stages Of the BidIdentifying the stages Of the Bid
EvaluationEvaluation
4.4. Identifying the Bid Evaluation FactorsIdentifying the Bid Evaluation Factors
5.5. Bid Evaluation ProcessBid Evaluation Process

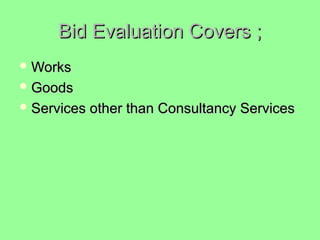

Bid Evaluation Covers ;Bid Evaluation Covers ;
 WorksWorks
 GoodsGoods
 Services other than Consultancy ServicesServices other than Consultancy Services

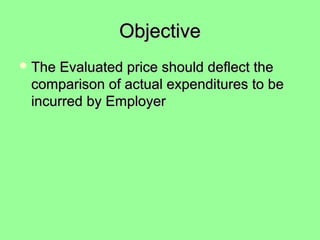

ObjectiveObjective
 The Evaluated price should deflect theThe Evaluated price should deflect the
comparison of actual expenditures to becomparison of actual expenditures to be
incurred by Employerincurred by Employer

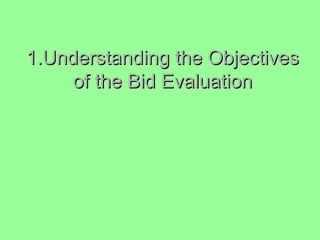

1.Understanding the Objectives1.Understanding the Objectives
of the Bid Evaluationof the Bid Evaluation
Monday, November 30, 2015Monday, November 30, 2015 66

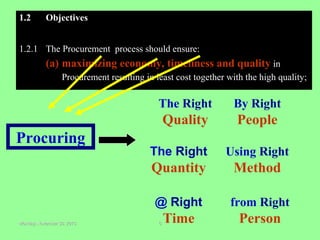

1.2 Objectives
1.2.1 The Procurement process should ensure:
(a) maximizing economy, timeliness and quality in
Procurement resulting in least cost together with the high quality;
Procuring
The Right
Quantity
The Right
Quality
@ Right
Time
By Right
People
Using Right
Method
from Right
Person

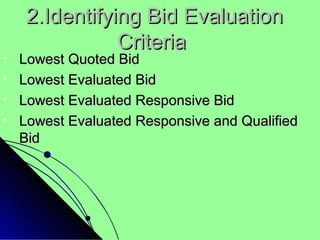

2.Identifying Bid Evaluation2.Identifying Bid Evaluation
CriteriaCriteria
• Lowest Quoted BidLowest Quoted Bid
• Lowest Evaluated BidLowest Evaluated Bid
• Lowest Evaluated Responsive BidLowest Evaluated Responsive Bid
• Lowest Evaluated Responsive and QualifiedLowest Evaluated Responsive and Qualified
BidBid

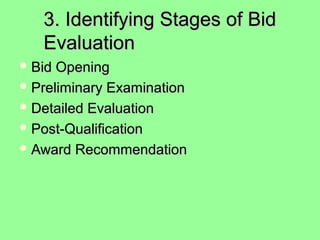

3. Identifying Stages of Bid3. Identifying Stages of Bid
EvaluationEvaluation
 Bid OpeningBid Opening
 Preliminary ExaminationPreliminary Examination
 Detailed EvaluationDetailed Evaluation
 Post-QualificationPost-Qualification
 Award RecommendationAward Recommendation

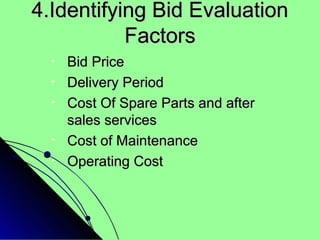

4.Identifying Bid Evaluation4.Identifying Bid Evaluation
FactorsFactors
• Bid PriceBid Price
• Delivery PeriodDelivery Period
• Cost Of Spare Parts and afterCost Of Spare Parts and after
sales servicessales services
• Cost of MaintenanceCost of Maintenance
• Operating CostOperating Cost

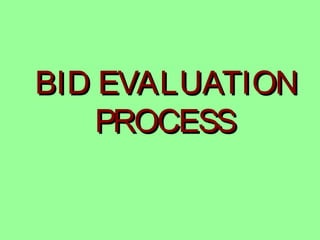

BID EVALUATIONBID EVALUATION
PROCESSPROCESS
Monday, November 30, 2015Monday, November 30, 2015 1111

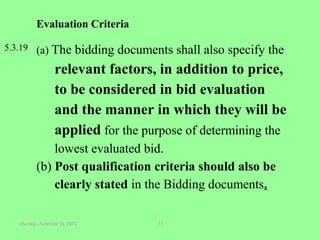

Evaluation Criteria
5.3.19 (a) The bidding documents shall also specify the
relevant factors, in addition to price,
to be considered in bid evaluation
and the manner in which they will be
applied for the purpose of determining the
lowest evaluated bid.
(b) Post qualification criteria should also be
clearly stated in the Bidding documents.
What is the objectiveWhat is the objective
of bid evaluation?of bid evaluation?
““Lowest Evaluated SubstantiallyLowest Evaluated Substantially
Responsive qualified Bid”,Responsive qualified Bid”,
TheObjectiveof Bid Evaluation is
to determinethe
among thebidssubmitted before
thebid closing timeon thedate
specified in thebidding documents.

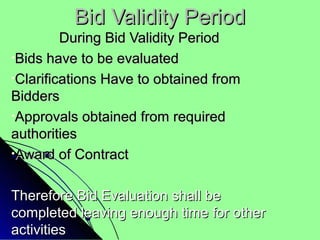

Bid Validity PeriodBid Validity Period
During Bid Validity PeriodDuring Bid Validity Period
•Bids have to be evaluatedBids have to be evaluated
•Clarifications Have to obtained fromClarifications Have to obtained from
BiddersBidders
•Approvals obtained from requiredApprovals obtained from required
authoritiesauthorities
•Award of ContractAward of Contract
Therefore Bid Evaluation shall beTherefore Bid Evaluation shall be
completed leaving enough time for othercompleted leaving enough time for other
activitiesactivities

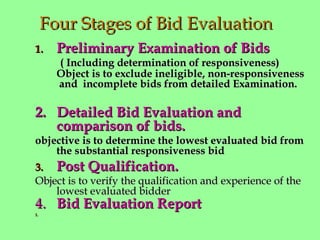

Four Stages of Bid EvaluationFour Stages of Bid Evaluation
1.1. Preliminary Examination of BidsPreliminary Examination of Bids
( Including determination of responsiveness)( Including determination of responsiveness)
Object is to exclude ineligible, non-responsivenessObject is to exclude ineligible, non-responsiveness
and incomplete bids from detailed Examination.and incomplete bids from detailed Examination.
2.2. Detailed Bid Evaluation andDetailed Bid Evaluation and
comparison of bids.comparison of bids.
objective is to determine the lowest evaluated bid fromobjective is to determine the lowest evaluated bid from
the substantial responsiveness bidthe substantial responsiveness bid
3.3. Post Qualification.Post Qualification.
Object is to verify the qualification and experience of theObject is to verify the qualification and experience of the
lowest evaluated bidderlowest evaluated bidder
4.4. Bid Evaluation ReportBid Evaluation Report..

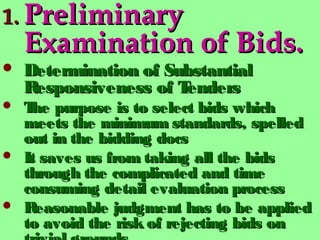

1.1.
1.1. PreliminaryPreliminary
Examination of Bids.Examination of Bids.
 Determination of SubstantialDetermination of Substantial
Responsiveness of TendersResponsiveness of Tenders
 The purpose is to select bids whichThe purpose is to select bids which
meets the minimum standards, spelledmeets the minimum standards, spelled
out in the bidding docsout in the bidding docs
 It saves us from taking all the bidsIt saves us from taking all the bids
through the complicated and timethrough the complicated and time
consuming detail evaluation processconsuming detail evaluation process
 Reasonable judgment has to be appliedReasonable judgment has to be applied
to avoid the risk of rejecting bids onto avoid the risk of rejecting bids on
Preliminary Examination

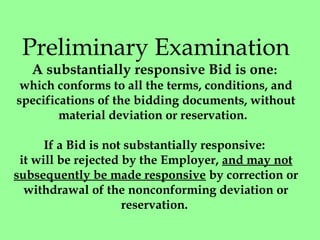

A substantially responsive Bid is one:
which conforms to all the terms, conditions, and
specifications of the bidding documents, without
material deviation or reservation.

If a Bid is not substantially responsive:
it will be rejected by the Employer, and may not
subsequently be made responsive by correction or
withdrawal of the nonconforming deviation or
reservation.

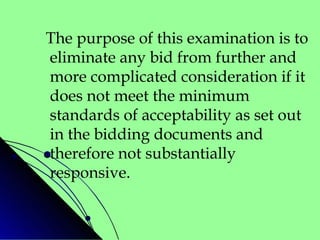

The purpose of this examination is to
eliminate any bid from further and
more complicated consideration if it
does not meet the minimum
standards of acceptability as set out
in the bidding documents and
therefore not substantially
responsive.

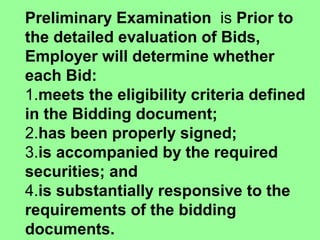

Preliminary Examination  is Prior to
the detailed evaluation of Bids,
Employer will determine whether
each Bid:
1.meets the eligibility criteria defined
in the Bidding document;
2.has been properly signed;
3.is accompanied by the required
securities; and
4.is substantially responsive to the
requirements of the bidding
documents.
COLLECTION OFTENDERCOLLECTION OFTENDER
INFORMATIONINFORMATION
 1. Collect the Basic Data1. Collect the Basic Data
 2. Record of TenderOpening2. Record of TenderOpening
 3. Preliminary Examination for3. Preliminary Examination for
Complete of Tenders.Complete of Tenders.

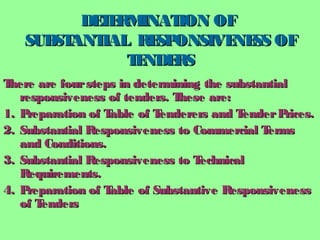

DETERMINATION OFDETERMINATION OF
SUBSTANTIAL RESPONSIVENESS OFSUBSTANTIAL RESPONSIVENESS OF
TENDERSTENDERS
There are foursteps in determining the substantialThere are foursteps in determining the substantial
responsiveness of tenders. These are:responsiveness of tenders. These are:
1.1. Preparation of Table of Tenderers and TenderPrices.Preparation of Table of Tenderers and TenderPrices.
2.2. Substantial Responsiveness to Commercial TermsSubstantial Responsiveness to Commercial Terms
and Conditions.and Conditions.
3.3. Substantial Responsiveness to TechnicalSubstantial Responsiveness to Technical
Requirements.Requirements.
4.4. Preparation of Table of Substantive ResponsivenessPreparation of Table of Substantive Responsiveness
of Tendersof Tenders

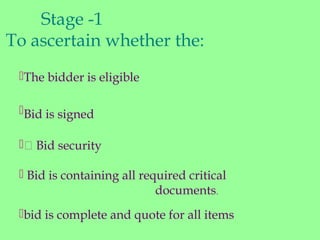

Stage -1
To ascertain whether the:
The bidder is eligible
Bid is signed
 Bid security
 Bid is containing all required critical
documents.
bid is complete and quote for all items

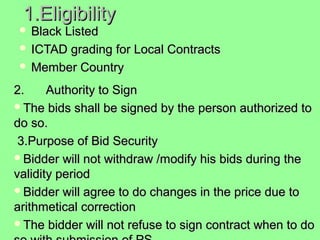

1.Eligibility 1.Eligibility
 Black ListedBlack Listed
 ICTAD grading for Local Contracts ICTAD grading for Local Contracts
 Member Country Member Country
2.2. Authority to SignAuthority to Sign
The bids shall be signed by the person authorized to The bids shall be signed by the person authorized to
do so.do so.
  3.Purpose of Bid Security 3.Purpose of Bid Security
Bidder will not withdraw /modify his bids during the Bidder will not withdraw /modify his bids during the
validity period validity period
Bidder will agree to do changes in the price due to Bidder will agree to do changes in the price due to
arithmetical correction arithmetical correction
The bidder will not refuse to sign contract when to do The bidder will not refuse to sign contract when to do

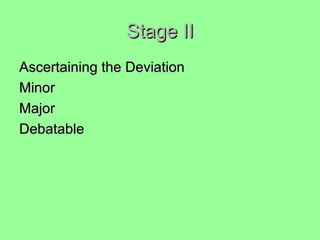

Stage IIStage II
Ascertaining the DeviationAscertaining the Deviation
MinorMinor
Major Major
Debatable Debatable

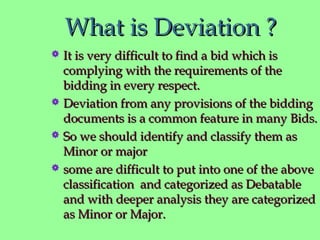

What is Deviation ?What is Deviation ?
 It is very difficult to find a bid which isIt is very difficult to find a bid which is
complying with the requirements of thecomplying with the requirements of the
bidding in every respect.bidding in every respect.
 Deviation from any provisions of the biddingDeviation from any provisions of the bidding
documents is a common feature in many Bids.documents is a common feature in many Bids.
 So we should identify and classify them asSo we should identify and classify them as
Minor or majorMinor or major
 some are difficult to put into one of the abovesome are difficult to put into one of the above
classification and categorized as Debatableclassification and categorized as Debatable
and with deeper analysis they are categorizedand with deeper analysis they are categorized
as Minor or Major.as Minor or Major.

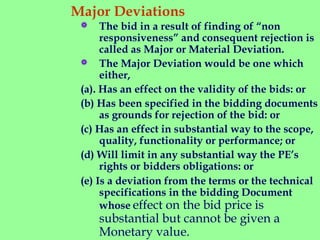

Major Deviations

 The bid in a result of finding of “non
responsiveness” and consequent rejection is
called as Major or Material Deviation.
 The Major Deviation would be one which
either,
(a). Has an effect on the validity of the bids: or
(b) Has been specified in the bidding documents
as grounds for rejection of the bid: or
(c) Has an effect in substantial way to the scope,
quality, functionality or performance; or
(d) Will limit in any substantial way the PE’s
rights or bidders obligations: or
(e) Is a deviation from the terms or the technical
specifications in the bidding Document
whose effect on the bid price is
substantial but cannot be given a
Monetary value.

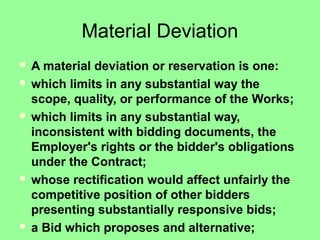

Material Deviation
 A material deviation or reservation is one:
 which limits in any substantial way the
scope, quality, or performance of the Works;
 which limits in any substantial way,
inconsistent with bidding documents, the
Employer's rights or the bidder's obligations
under the Contract;
 whose rectification would affect unfairly the
competitive position of other bidders
presenting substantially responsive bids;
 a Bid which proposes and alternative;

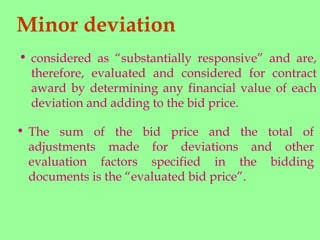

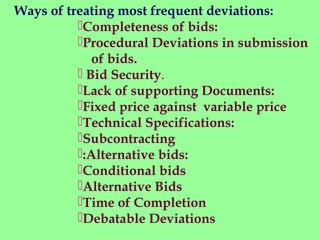

Minor deviation
• The sum of the bid price and the total of
adjustments made for deviations and other
evaluation factors specified in the bidding
documents is the “evaluated bid price”.
• considered as “substantially responsive” and are,
therefore, evaluated and considered for contract
award by determining any financial value of each
deviation and adding to the bid price.

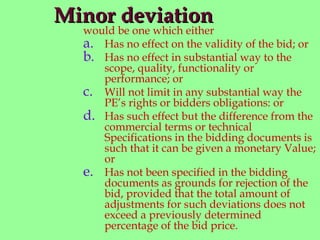

Minor deviationMinor deviation
would be one which either
a. Has no effect on the validity of the bid; or
b. Has no effect in substantial way to the
scope, quality, functionality or
performance; or
c. Will not limit in any substantial way the
PE’s rights or bidders obligations: or
d. Has such effect but the difference from the
commercial terms or technical
Specifications in the bidding documents is
such that it can be given a monetary Value;
or
e. Has not been specified in the bidding
documents as grounds for rejection of the
bid, provided that the total amount of
adjustments for such deviations does not
exceed a previously determined
percentage of the bid price.
Debatable DeviationsDebatable Deviations
 Requesting different amount of advanceRequesting different amount of advance
and other payment termsand other payment terms (including(including
liquidated damages and retention):liquidated damages and retention):
 Late RecoveryLate Recovery
 Recovery up to last BillRecovery up to last Bill
 RetentionRetention
 Liquidated DamagesLiquidated Damages
 Proposed changes in construction periodProposed changes in construction period
which is not criticalwhich is not critical::
 Omissions of minor works or itemsOmissions of minor works or items
included in the scope of workincluded in the scope of work
Completeness of bids:
Procedural Deviations in submission
of bids.
 Bid Security.
Lack of supporting Documents:
Fixed price against variable price
Technical Specifications:
Subcontracting
:Alternative bids:
Conditional bids
Alternative Bids
Time of Completion
Debatable Deviations
Ways of treating most frequent deviations:

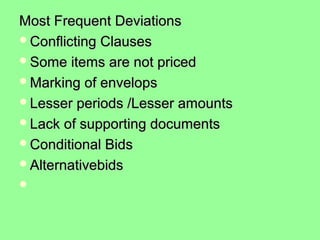

Most Frequent DeviationsMost Frequent Deviations
Conflicting ClausesConflicting Clauses
Some items are not pricedSome items are not priced
Marking of envelopsMarking of envelops
Lesser periods /Lesser amountsLesser periods /Lesser amounts
Lack of supporting documentsLack of supporting documents
Conditional BidsConditional Bids
AlternativebidsAlternativebids

Stage 2Stage 2

DETAILEDEVALUATION OF
TENDER
1.Technical Analysis;
2.Commercial Analysis;
and
3.Financial Analysis.

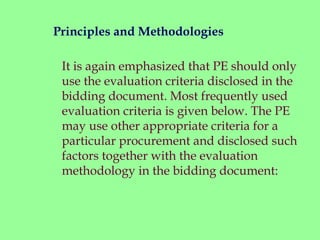

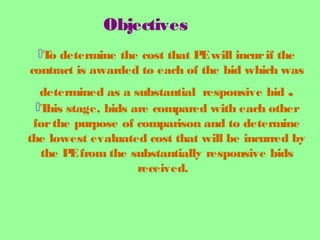

Objectives
To determine the cost that PEwill incurif the
contract is awarded to each of the bid which was
determined as a substantial responsive bid .
This stage, bids are compared with each other
forthe purpose of comparison and to determine
the lowest evaluated cost that will be incurred by
the PEfrom the substantially responsive bids
received.

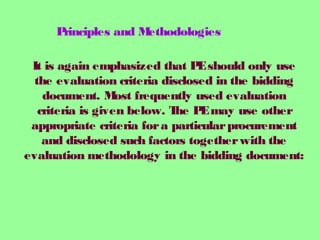

It is again emphasized that PEshould only use
the evaluation criteria disclosed in the bidding
document. Most frequently used evaluation
criteria is given below. The PEmay use other
appropriate criteria fora particularprocurement
and disclosed such factors togetherwith the
evaluation methodology in the bidding document:
Principles and Methodologies

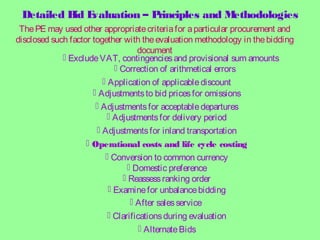

Detailed Bid Evaluation – Principles and Methodologies
ThePE may used other appropriatecriteriafor aparticular procurement and
disclosed such factor together with theevaluation methodology in thebidding
document
 ExcludeVAT, contingenciesand provisional sum amounts
 Correction of arithmetical errors
 Application of applicablediscount
 Adjustmentsfor acceptabledepartures
 Adjustmentsfor delivery period
 Adjustmentsto bid pricesfor omissions
 Adjustmentsfor inland transportation
 AlternateBids
 Conversion to common currency
 Domestic preference
 Reassessranking order
 Examinefor unbalancebidding
 After salesservice
 Clarificationsduring evaluation
 Operational costs and life cycle costing
Clarifications during evaluation:Clarifications during evaluation:
 if the Bid is any doubt about the intent ofif the Bid is any doubt about the intent of
the bidder. Modifications of thethe bidder. Modifications of the
substances of the bid by a bidder are,substances of the bid by a bidder are,
 however, not allowed. Any change inhowever, not allowed. Any change in
price, delivery terms, conditions ofprice, delivery terms, conditions of
contract or change of specificationscontract or change of specifications
proposed by the bidder is considered asproposed by the bidder is considered as
substantive.substantive.
 modifications. The PE should not changemodifications. The PE should not change
any of the commercial terms or technicalany of the commercial terms or technical
specifications as a result of clarifications.specifications as a result of clarifications.

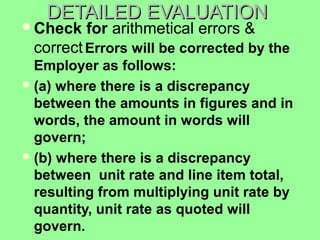

DETAILED EVALUATIONDETAILED EVALUATION
Check for arithmetical errors &
correctErrors will be corrected by the
Employer as follows:

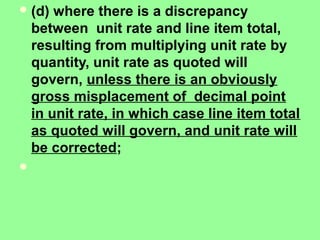

(a) where there is a discrepancy
between the amounts in figures and in
words, the amount in words will
govern;
(b) where there is a discrepancy
between unit rate and line item total,
resulting from multiplying unit rate by
quantity, unit rate as quoted will
govern.
(c) unless this sub-clause is modified

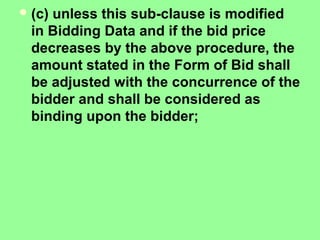

in Bidding Data and if the bid price
decreases by the above procedure, the
amount stated in the Form of Bid shall
be adjusted with the concurrence of the
bidder and shall be considered as
binding upon the bidder;
(d) where there is a discrepancy
between unit rate and line item total,
resulting from multiplying unit rate by
quantity, unit rate as quoted will
govern, unless there is an obviously
gross misplacement of decimal point
in unit rate, in which case line item total
as quoted will govern, and unit rate will
be corrected;


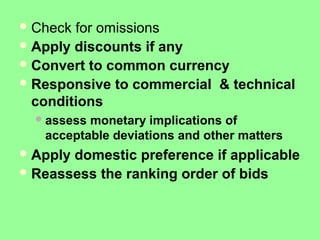

Check for omissions
Apply discounts if any
Convert to common currency
Responsive to commercial & technical
conditions
assess monetary implications of
acceptable deviations and other matters
Apply domestic preference if applicable
Reassess the ranking order of bids

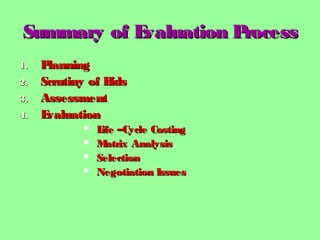

Summary of Evaluation ProcessSummary of Evaluation Process
1.1. PlanningPlanning
2.2. Scrutiny of BidsScrutiny of Bids
3.3. AssessmentAssessment
4.4. EvaluationEvaluation
 Life –Cycle CostingLife –Cycle Costing
 Matrix AnalysisMatrix Analysis
 SelectionSelection
 Negotiation IssuesNegotiation Issues
Commercial Analysis of Substantial
Responsiveness of Tenders.
Technical Analysis of Substantial
Responsiveness of Tenders.
Financial Analysis of Substantial
Responsiveness of Tenders.
Detailed Evaluation of Substantially
Responsive Tenders
 COMMERCIALANALYSISCOMMERCIALANALYSIS
The Table forCommercial Terms should list all theThe Table forCommercial Terms should list all the
important commercial conditions specified in theimportant commercial conditions specified in the
tendering documents such as:tendering documents such as:
• The tendersecurity amount and validity
period;
• Terms of payment;
• Liquidated damages etc.; and
• Any deviations from requirements of the
tendering documents.
Further, it should be stated whethera financial
adjustment to the tenderis considered necessary
as a consequence of any minordeviation
TECHNICALANALYSISTECHNICALANALYSIS

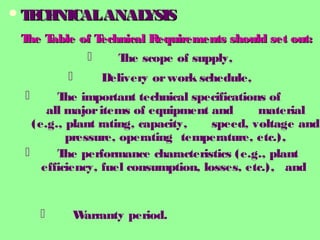

The Table of Technical Requirements should set out:The Table of Technical Requirements should set out:
 The scope of supply,
 Delivery orwork schedule,
 The important technical specifications of
all majoritems of equipment and material
(e.g., plant rating, capacity, speed, voltage and
pressure, operating temperature, etc.),
 The performance characteristics (e.g., plant
efficiency, fuel consumption, losses, etc.), and
 Warranty period.

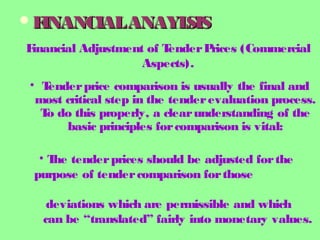

FINANCIALANAYLSISFINANCIALANAYLSIS
Financial Adjustment of TenderPrices (Commercial
Aspects).
• Tenderprice comparison is usually the final and
most critical step in the tenderevaluation process.
To do this properly, a clearunderstanding of the
basic principles forcomparison is vital:
• The tenderprices should be adjusted forthe
purpose of tendercomparison forthose
deviations which are permissible and which
can be “translated” fairly into monetary values.

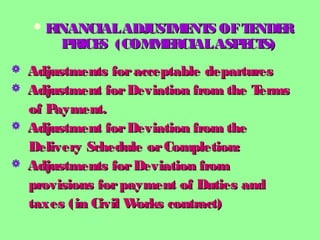

 FINANCIALADJUSTMENTS OFTENDERFINANCIALADJUSTMENTS OFTENDER
PRICES (COMMERCIALASPECTS)PRICES (COMMERCIALASPECTS)
 Adjustments foracceptable departuresAdjustments foracceptable departures
 Adjustment forDeviation from the TermsAdjustment forDeviation from the Terms
of Payment.of Payment.
 Adjustment forDeviation from theAdjustment forDeviation from the
Delivery Schedule orCompletion:Delivery Schedule orCompletion:
 Adjustments forDeviation fromAdjustments forDeviation from
provisions forpayment of Duties andprovisions forpayment of Duties and
taxes (in Civil Works contract)taxes (in Civil Works contract)
•FINANCIALADJUSTMENTS OFTENDERPRICES
(TECHNICALASPECTS)
 Adjustment forCompleteness in Scope of
Supply
 Adjustment forTechnical Compliance
 Adjustment forSpecified Technical Evaluation
Factors
 Adjustment forSpare Parts
 Aftersales Services
 Maximum Amount of Adjustment fordeviation
 Adjustment forCost of Inland Transportation
to the Project Site –INCOTERMS

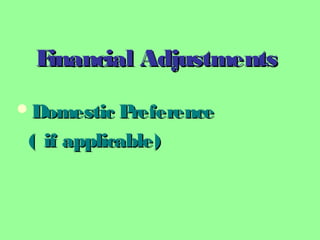

Financial AdjustmentsFinancial Adjustments
Domestic PreferenceDomestic Preference
( if applicable)( if applicable)

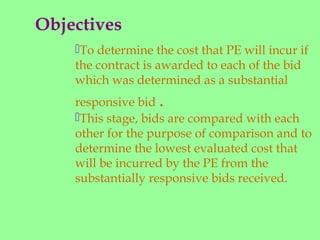

Objectives
To determine the cost that PE will incur if
the contract is awarded to each of the bid
which was determined as a substantial
responsive bid .
This stage, bids are compared with each
other for the purpose of comparison and to
determine the lowest evaluated cost that
will be incurred by the PE from the
substantially responsive bids received.
It is again emphasized that PE should only
use the evaluation criteria disclosed in the
bidding document. Most frequently used
evaluation criteria is given below. The PE
may use other appropriate criteria for a
particular procurement and disclosed such
factors together with the evaluation
methodology in the bidding document:
Principles and Methodologies

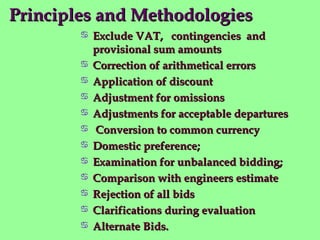

Principles and MethodologiesPrinciples and Methodologies
 Exclude VAT, contingencies andExclude VAT, contingencies and
provisional sum amountsprovisional sum amounts
 Correction of arithmetical errorsCorrection of arithmetical errors
 Application of discountApplication of discount
 Adjustment for omissionsAdjustment for omissions
 Adjustments for acceptable departuresAdjustments for acceptable departures
 Conversion to common currencyConversion to common currency
 Domestic preference;Domestic preference;
 Examination for unbalanced bidding;Examination for unbalanced bidding;
 Comparison with engineers estimateComparison with engineers estimate
 Rejection of all bidsRejection of all bids
 Clarifications during evaluationClarifications during evaluation
 Alternate Bids.Alternate Bids.
3. Post3. Post
qualificationqualification
Post qualificationPost qualification
 Post qualification is suitable for use in thePost qualification is suitable for use in the
procurement of works contracts, whichprocurement of works contracts, which
are not complicated where pre-are not complicated where pre-
qualification does not offer muchqualification does not offer much
advantage.advantage.
 Post -qualification is a distinct step in bidPost -qualification is a distinct step in bid
evaluation.evaluation.
Post qualificationPost qualification

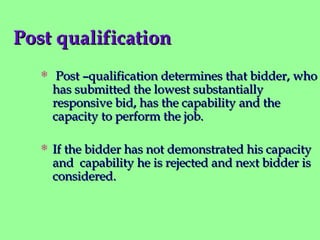

 Post –qualification determines that bidder, whoPost –qualification determines that bidder, who
has submitted the lowest substantiallyhas submitted the lowest substantially
responsive bid, has the capability and theresponsive bid, has the capability and the
capacity to perform the job.capacity to perform the job.
 If the bidder has not demonstrated his capacityIf the bidder has not demonstrated his capacity
and capability he is rejected and next bidder isand capability he is rejected and next bidder is
considered.considered.
Post -qualificationPost -qualification
 Post –qualification criteria shall be
clearly spelled out in the bidding
documents
 Relevant forms & questionnaires
shall be included in the bidding
documents to extract data in a
uniform mater.
 The PE can use the data it gathered
in addition to the data submitted by
the bidder

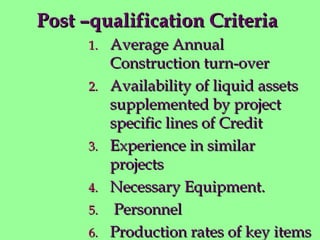

Post –qualification CriteriaPost –qualification Criteria
1.1. Average AnnualAverage Annual
Construction turn-overConstruction turn-over
2.2. Availability of liquid assetsAvailability of liquid assets
supplemented by projectsupplemented by project
specific lines of Creditspecific lines of Credit
3.3. Experience in similarExperience in similar
projectsprojects
4.4. Necessary Equipment.Necessary Equipment.
5.5. PersonnelPersonnel
6.6. Production rates of key itemsProduction rates of key items
4. Bid Evaluation4. Bid Evaluation
ReportReport
Bid Evaluation ReportBid Evaluation Report
 After the completion of the evaluationAfter the completion of the evaluation
process the PE should prepare a bidprocess the PE should prepare a bid
evaluation report setting out process ofevaluation report setting out process of
evaluation. The PE shall use standardevaluation. The PE shall use standard
forms available for the purpose.forms available for the purpose.
 In addition the evaluation report shouldIn addition the evaluation report should
include narrative section in which anyinclude narrative section in which any
Information not suitable for presentationInformation not suitable for presentation
in the form of tables, together with anyin the form of tables, together with any
Supplementary information necessary forSupplementary information necessary for
a complete understanding of all thea complete understanding of all the
factors considered during bid evaluation.factors considered during bid evaluation.
Thank youThank you

4th Day Basic PPT

  • 1.
    Bid EvaluationBid EvaluationEng.V.Mohan./ Project Director- CENTRAL EXPRESSWAY PROJECT-II, M.Sc(PPM, Turin, Italy), Dip.In Com.Com. Arb (ICLP),DIPPCA (SL), FCIHT(Lond), FIE(SL), B.Sc(Eng),MIE (SL) ROAD DEVELOPMENT AUTHORITY 3rd Floor, "Sethsiripaya ", Battaramulla, CO 10120, Sri Lanka,  Office :-+94112877708 - Extension -126 Mobile: +94-77 316 8726, +94 71 843 3070 Home ;+94112322070 Fax No.+94112877708 Email: nsvmohan@gmail.com
  • 2.
    Learning ObjectivesLearning Objectives 1.1.Understanding the objectives of the BidUnderstanding the objectives of the Bid EvaluationEvaluation 2.2. Identifying the Evaluation CriteriaIdentifying the Evaluation Criteria 3.3. Identifying the stages Of the BidIdentifying the stages Of the Bid EvaluationEvaluation 4.4. Identifying the Bid Evaluation FactorsIdentifying the Bid Evaluation Factors 5.5. Bid Evaluation ProcessBid Evaluation Process
  • 3.
    Bid Evaluation Covers;Bid Evaluation Covers ;  WorksWorks  GoodsGoods  Services other than Consultancy ServicesServices other than Consultancy Services
  • 4.
    ObjectiveObjective  The Evaluatedprice should deflect theThe Evaluated price should deflect the comparison of actual expenditures to becomparison of actual expenditures to be incurred by Employerincurred by Employer
  • 5.
    1.Understanding the Objectives1.Understandingthe Objectives of the Bid Evaluationof the Bid Evaluation
  • 6.
    Monday, November 30,2015Monday, November 30, 2015 66 1.2 Objectives 1.2.1 The Procurement process should ensure: (a) maximizing economy, timeliness and quality in Procurement resulting in least cost together with the high quality; Procuring The Right  Quantity The Right Quality @ Right  Time By Right People Using Right Method from Right Person
  • 7.
    2.Identifying Bid Evaluation2.IdentifyingBid Evaluation CriteriaCriteria • Lowest Quoted BidLowest Quoted Bid • Lowest Evaluated BidLowest Evaluated Bid • Lowest Evaluated Responsive BidLowest Evaluated Responsive Bid • Lowest Evaluated Responsive and QualifiedLowest Evaluated Responsive and Qualified BidBid
  • 8.
    3. Identifying Stagesof Bid3. Identifying Stages of Bid EvaluationEvaluation  Bid OpeningBid Opening  Preliminary ExaminationPreliminary Examination  Detailed EvaluationDetailed Evaluation  Post-QualificationPost-Qualification  Award RecommendationAward Recommendation
  • 9.
    4.Identifying Bid Evaluation4.IdentifyingBid Evaluation FactorsFactors • Bid PriceBid Price • Delivery PeriodDelivery Period • Cost Of Spare Parts and afterCost Of Spare Parts and after sales servicessales services • Cost of MaintenanceCost of Maintenance • Operating CostOperating Cost
  • 10.
  • 11.
    Monday, November 30,2015Monday, November 30, 2015 1111 Evaluation Criteria 5.3.19 (a) The bidding documents shall also specify the relevant factors, in addition to price, to be considered in bid evaluation and the manner in which they will be applied for the purpose of determining the lowest evaluated bid. (b) Post qualification criteria should also be clearly stated in the Bidding documents.
  • 12.
    What is theobjectiveWhat is the objective of bid evaluation?of bid evaluation?
  • 13.
    ““Lowest Evaluated SubstantiallyLowestEvaluated Substantially Responsive qualified Bid”,Responsive qualified Bid”, TheObjectiveof Bid Evaluation is to determinethe among thebidssubmitted before thebid closing timeon thedate specified in thebidding documents.
  • 14.
    Bid Validity PeriodBidValidity Period During Bid Validity PeriodDuring Bid Validity Period •Bids have to be evaluatedBids have to be evaluated •Clarifications Have to obtained fromClarifications Have to obtained from BiddersBidders •Approvals obtained from requiredApprovals obtained from required authoritiesauthorities •Award of ContractAward of Contract Therefore Bid Evaluation shall beTherefore Bid Evaluation shall be completed leaving enough time for othercompleted leaving enough time for other activitiesactivities
  • 15.
    Four Stages ofBid EvaluationFour Stages of Bid Evaluation 1.1. Preliminary Examination of BidsPreliminary Examination of Bids ( Including determination of responsiveness)( Including determination of responsiveness) Object is to exclude ineligible, non-responsivenessObject is to exclude ineligible, non-responsiveness and incomplete bids from detailed Examination.and incomplete bids from detailed Examination. 2.2. Detailed Bid Evaluation andDetailed Bid Evaluation and comparison of bids.comparison of bids. objective is to determine the lowest evaluated bid fromobjective is to determine the lowest evaluated bid from the substantial responsiveness bidthe substantial responsiveness bid 3.3. Post Qualification.Post Qualification. Object is to verify the qualification and experience of theObject is to verify the qualification and experience of the lowest evaluated bidderlowest evaluated bidder 4.4. Bid Evaluation ReportBid Evaluation Report.. 1.1.
  • 16.
    1.1. PreliminaryPreliminary Examination ofBids.Examination of Bids.  Determination of SubstantialDetermination of Substantial Responsiveness of TendersResponsiveness of Tenders  The purpose is to select bids whichThe purpose is to select bids which meets the minimum standards, spelledmeets the minimum standards, spelled out in the bidding docsout in the bidding docs  It saves us from taking all the bidsIt saves us from taking all the bids through the complicated and timethrough the complicated and time consuming detail evaluation processconsuming detail evaluation process  Reasonable judgment has to be appliedReasonable judgment has to be applied to avoid the risk of rejecting bids onto avoid the risk of rejecting bids on
  • 17.
    Preliminary Examination A substantiallyresponsive Bid is one:  which conforms to all the terms, conditions, and specifications of the bidding documents, without material deviation or reservation.    If a Bid is not substantially responsive:  it will be rejected by the Employer, and may not subsequently be made responsive by correction or withdrawal of the nonconforming deviation or reservation.
  • 18.
    The purpose ofthis examination is to eliminate any bid from further and more complicated consideration if it does not meet the minimum standards of acceptability as set out in the bidding documents and therefore not substantially responsive.
  • 19.
    Preliminary Examination  is Prior to thedetailed evaluation of Bids, Employer will determine whether each Bid:  1.meets the eligibility criteria defined in the Bidding document;  2.has been properly signed; 3.is accompanied by the required securities; and 4.is substantially responsive to the requirements of the bidding documents.
  • 20.
    COLLECTION OFTENDERCOLLECTION OFTENDER INFORMATIONINFORMATION 1. Collect the Basic Data1. Collect the Basic Data  2. Record of TenderOpening2. Record of TenderOpening  3. Preliminary Examination for3. Preliminary Examination for Complete of Tenders.Complete of Tenders.
  • 21.
    DETERMINATION OFDETERMINATION OF SUBSTANTIALRESPONSIVENESS OFSUBSTANTIAL RESPONSIVENESS OF TENDERSTENDERS There are foursteps in determining the substantialThere are foursteps in determining the substantial responsiveness of tenders. These are:responsiveness of tenders. These are: 1.1. Preparation of Table of Tenderers and TenderPrices.Preparation of Table of Tenderers and TenderPrices. 2.2. Substantial Responsiveness to Commercial TermsSubstantial Responsiveness to Commercial Terms and Conditions.and Conditions. 3.3. Substantial Responsiveness to TechnicalSubstantial Responsiveness to Technical Requirements.Requirements. 4.4. Preparation of Table of Substantive ResponsivenessPreparation of Table of Substantive Responsiveness of Tendersof Tenders
  • 22.
    Stage -1 To ascertainwhether the: The bidder is eligible Bid is signed  Bid security  Bid is containing all required critical documents. bid is complete and quote for all items
  • 23.
    1.Eligibility 1.Eligibility   Black ListedBlack Listed  ICTAD grading for Local Contracts ICTAD grading for Local Contracts  Member Country Member Country  2.2. Authority to SignAuthority to Sign The bids shall be signed by the person authorized to The bids shall be signed by the person authorized to  do so.do so.   3.Purpose of Bid Security 3.Purpose of Bid Security  Bidder will not withdraw /modify his bids during the Bidder will not withdraw /modify his bids during the  validity period validity period  Bidder will agree to do changes in the price due to Bidder will agree to do changes in the price due to  arithmetical correction arithmetical correction  The bidder will not refuse to sign contract when to do The bidder will not refuse to sign contract when to do
  • 24.
  • 25.
    What is Deviation?What is Deviation ?  It is very difficult to find a bid which isIt is very difficult to find a bid which is complying with the requirements of thecomplying with the requirements of the bidding in every respect.bidding in every respect.  Deviation from any provisions of the biddingDeviation from any provisions of the bidding documents is a common feature in many Bids.documents is a common feature in many Bids.  So we should identify and classify them asSo we should identify and classify them as Minor or majorMinor or major  some are difficult to put into one of the abovesome are difficult to put into one of the above classification and categorized as Debatableclassification and categorized as Debatable and with deeper analysis they are categorizedand with deeper analysis they are categorized as Minor or Major.as Minor or Major.
  • 26.
    Major Deviations     Thebid in a result of finding of “non responsiveness” and consequent rejection is called as Major or Material Deviation.  The Major Deviation would be one which either, (a). Has an effect on the validity of the bids: or (b) Has been specified in the bidding documents as grounds for rejection of the bid: or (c) Has an effect in substantial way to the scope, quality, functionality or performance; or (d) Will limit in any substantial way the PE’s rights or bidders obligations: or (e) Is a deviation from the terms or the technical specifications in the bidding Document whose effect on the bid price is substantial but cannot be given a Monetary value.
  • 27.
    Material Deviation  A materialdeviation or reservation is one:  which limits in any substantial way the scope, quality, or performance of the Works;  which limits in any substantial way, inconsistent with bidding documents, the Employer's rights or the bidder's obligations under the Contract;  whose rectification would affect unfairly the competitive position of other bidders presenting substantially responsive bids;  a Bid which proposes and alternative;
  • 28.
    Minor deviation • Thesum of the bid price and the total of adjustments made for deviations and other evaluation factors specified in the bidding documents is the “evaluated bid price”. • considered as “substantially responsive” and are, therefore, evaluated and considered for contract award by determining any financial value of each deviation and adding to the bid price.
  • 29.
    Minor deviationMinor deviation wouldbe one which either a. Has no effect on the validity of the bid; or b. Has no effect in substantial way to the scope, quality, functionality or performance; or c. Will not limit in any substantial way the PE’s rights or bidders obligations: or d. Has such effect but the difference from the commercial terms or technical Specifications in the bidding documents is such that it can be given a monetary Value; or e. Has not been specified in the bidding documents as grounds for rejection of the bid, provided that the total amount of adjustments for such deviations does not exceed a previously determined percentage of the bid price.
  • 30.
    Debatable DeviationsDebatable Deviations Requesting different amount of advanceRequesting different amount of advance and other payment termsand other payment terms (including(including liquidated damages and retention):liquidated damages and retention):  Late RecoveryLate Recovery  Recovery up to last BillRecovery up to last Bill  RetentionRetention  Liquidated DamagesLiquidated Damages  Proposed changes in construction periodProposed changes in construction period which is not criticalwhich is not critical::  Omissions of minor works or itemsOmissions of minor works or items included in the scope of workincluded in the scope of work
  • 31.
    Completeness of bids: ProceduralDeviations in submission of bids.  Bid Security. Lack of supporting Documents: Fixed price against variable price Technical Specifications: Subcontracting :Alternative bids: Conditional bids Alternative Bids Time of Completion Debatable Deviations Ways of treating most frequent deviations:
  • 32.
    Most Frequent DeviationsMostFrequent Deviations Conflicting ClausesConflicting Clauses Some items are not pricedSome items are not priced Marking of envelopsMarking of envelops Lesser periods /Lesser amountsLesser periods /Lesser amounts Lack of supporting documentsLack of supporting documents Conditional BidsConditional Bids AlternativebidsAlternativebids 
  • 33.
    Stage 2Stage 2  DETAILEDEVALUATIONOF TENDER 1.Technical Analysis; 2.Commercial Analysis; and 3.Financial Analysis.
  • 34.
    Objectives To determine thecost that PEwill incurif the contract is awarded to each of the bid which was determined as a substantial responsive bid . This stage, bids are compared with each other forthe purpose of comparison and to determine the lowest evaluated cost that will be incurred by the PEfrom the substantially responsive bids received.
  • 35.
    It is againemphasized that PEshould only use the evaluation criteria disclosed in the bidding document. Most frequently used evaluation criteria is given below. The PEmay use other appropriate criteria fora particularprocurement and disclosed such factors togetherwith the evaluation methodology in the bidding document: Principles and Methodologies
  • 36.
    Detailed Bid Evaluation– Principles and Methodologies ThePE may used other appropriatecriteriafor aparticular procurement and disclosed such factor together with theevaluation methodology in thebidding document  ExcludeVAT, contingenciesand provisional sum amounts  Correction of arithmetical errors  Application of applicablediscount  Adjustmentsfor acceptabledepartures  Adjustmentsfor delivery period  Adjustmentsto bid pricesfor omissions  Adjustmentsfor inland transportation  AlternateBids  Conversion to common currency  Domestic preference  Reassessranking order  Examinefor unbalancebidding  After salesservice  Clarificationsduring evaluation  Operational costs and life cycle costing
  • 37.
    Clarifications during evaluation:Clarificationsduring evaluation:  if the Bid is any doubt about the intent ofif the Bid is any doubt about the intent of the bidder. Modifications of thethe bidder. Modifications of the substances of the bid by a bidder are,substances of the bid by a bidder are,  however, not allowed. Any change inhowever, not allowed. Any change in price, delivery terms, conditions ofprice, delivery terms, conditions of contract or change of specificationscontract or change of specifications proposed by the bidder is considered asproposed by the bidder is considered as substantive.substantive.  modifications. The PE should not changemodifications. The PE should not change any of the commercial terms or technicalany of the commercial terms or technical specifications as a result of clarifications.specifications as a result of clarifications.
  • 38.
    DETAILED EVALUATIONDETAILED EVALUATION Checkfor arithmetical errors & correctErrors will be corrected by the Employer as follows: (a) where there is a discrepancy between the amounts in figures and in words, the amount in words will govern; (b) where there is a discrepancy between unit rate and line item total, resulting from multiplying unit rate by quantity, unit rate as quoted will govern.
  • 39.
    (c) unless thissub-clause is modified in Bidding Data and if the bid price decreases by the above procedure, the amount stated in the Form of Bid shall be adjusted with the concurrence of the bidder and shall be considered as binding upon the bidder;
  • 40.
    (d) where thereis a discrepancy between unit rate and line item total, resulting from multiplying unit rate by quantity, unit rate as quoted will govern, unless there is an obviously gross misplacement of decimal point in unit rate, in which case line item total as quoted will govern, and unit rate will be corrected; 
  • 41.
    Check for omissions Applydiscounts if any Convert to common currency Responsive to commercial & technical conditions assess monetary implications of acceptable deviations and other matters Apply domestic preference if applicable Reassess the ranking order of bids
  • 42.
    Summary of EvaluationProcessSummary of Evaluation Process 1.1. PlanningPlanning 2.2. Scrutiny of BidsScrutiny of Bids 3.3. AssessmentAssessment 4.4. EvaluationEvaluation  Life –Cycle CostingLife –Cycle Costing  Matrix AnalysisMatrix Analysis  SelectionSelection  Negotiation IssuesNegotiation Issues
  • 43.
    Commercial Analysis ofSubstantial Responsiveness of Tenders. Technical Analysis of Substantial Responsiveness of Tenders. Financial Analysis of Substantial Responsiveness of Tenders. Detailed Evaluation of Substantially Responsive Tenders
  • 44.
     COMMERCIALANALYSISCOMMERCIALANALYSIS The TableforCommercial Terms should list all theThe Table forCommercial Terms should list all the important commercial conditions specified in theimportant commercial conditions specified in the tendering documents such as:tendering documents such as: • The tendersecurity amount and validity period; • Terms of payment; • Liquidated damages etc.; and • Any deviations from requirements of the tendering documents. Further, it should be stated whethera financial adjustment to the tenderis considered necessary as a consequence of any minordeviation
  • 45.
    TECHNICALANALYSISTECHNICALANALYSIS The Table ofTechnical Requirements should set out:The Table of Technical Requirements should set out:  The scope of supply,  Delivery orwork schedule,  The important technical specifications of all majoritems of equipment and material (e.g., plant rating, capacity, speed, voltage and pressure, operating temperature, etc.),  The performance characteristics (e.g., plant efficiency, fuel consumption, losses, etc.), and  Warranty period.
  • 46.
    FINANCIALANAYLSISFINANCIALANAYLSIS Financial Adjustment ofTenderPrices (Commercial Aspects). • Tenderprice comparison is usually the final and most critical step in the tenderevaluation process. To do this properly, a clearunderstanding of the basic principles forcomparison is vital: • The tenderprices should be adjusted forthe purpose of tendercomparison forthose deviations which are permissible and which can be “translated” fairly into monetary values.
  • 47.
     FINANCIALADJUSTMENTS OFTENDERFINANCIALADJUSTMENTSOFTENDER PRICES (COMMERCIALASPECTS)PRICES (COMMERCIALASPECTS)  Adjustments foracceptable departuresAdjustments foracceptable departures  Adjustment forDeviation from the TermsAdjustment forDeviation from the Terms of Payment.of Payment.  Adjustment forDeviation from theAdjustment forDeviation from the Delivery Schedule orCompletion:Delivery Schedule orCompletion:  Adjustments forDeviation fromAdjustments forDeviation from provisions forpayment of Duties andprovisions forpayment of Duties and taxes (in Civil Works contract)taxes (in Civil Works contract)
  • 48.
    •FINANCIALADJUSTMENTS OFTENDERPRICES (TECHNICALASPECTS)  AdjustmentforCompleteness in Scope of Supply  Adjustment forTechnical Compliance  Adjustment forSpecified Technical Evaluation Factors  Adjustment forSpare Parts  Aftersales Services  Maximum Amount of Adjustment fordeviation  Adjustment forCost of Inland Transportation to the Project Site –INCOTERMS
  • 49.
    Financial AdjustmentsFinancial Adjustments DomesticPreferenceDomestic Preference ( if applicable)( if applicable)
  • 50.
    Objectives To determine thecost that PE will incur if the contract is awarded to each of the bid which was determined as a substantial responsive bid . This stage, bids are compared with each other for the purpose of comparison and to determine the lowest evaluated cost that will be incurred by the PE from the substantially responsive bids received.
  • 51.
    It is againemphasized that PE should only use the evaluation criteria disclosed in the bidding document. Most frequently used evaluation criteria is given below. The PE may use other appropriate criteria for a particular procurement and disclosed such factors together with the evaluation methodology in the bidding document: Principles and Methodologies
  • 52.
    Principles and MethodologiesPrinciplesand Methodologies  Exclude VAT, contingencies andExclude VAT, contingencies and provisional sum amountsprovisional sum amounts  Correction of arithmetical errorsCorrection of arithmetical errors  Application of discountApplication of discount  Adjustment for omissionsAdjustment for omissions  Adjustments for acceptable departuresAdjustments for acceptable departures  Conversion to common currencyConversion to common currency  Domestic preference;Domestic preference;  Examination for unbalanced bidding;Examination for unbalanced bidding;  Comparison with engineers estimateComparison with engineers estimate  Rejection of all bidsRejection of all bids  Clarifications during evaluationClarifications during evaluation  Alternate Bids.Alternate Bids.
  • 53.
  • 54.
    Post qualificationPost qualification Post qualification is suitable for use in thePost qualification is suitable for use in the procurement of works contracts, whichprocurement of works contracts, which are not complicated where pre-are not complicated where pre- qualification does not offer muchqualification does not offer much advantage.advantage.  Post -qualification is a distinct step in bidPost -qualification is a distinct step in bid evaluation.evaluation.
  • 55.
    Post qualificationPost qualification Post –qualification determines that bidder, whoPost –qualification determines that bidder, who has submitted the lowest substantiallyhas submitted the lowest substantially responsive bid, has the capability and theresponsive bid, has the capability and the capacity to perform the job.capacity to perform the job.  If the bidder has not demonstrated his capacityIf the bidder has not demonstrated his capacity and capability he is rejected and next bidder isand capability he is rejected and next bidder is considered.considered.
  • 56.
    Post -qualificationPost -qualification Post –qualification criteria shall be clearly spelled out in the bidding documents  Relevant forms & questionnaires shall be included in the bidding documents to extract data in a uniform mater.  The PE can use the data it gathered in addition to the data submitted by the bidder
  • 57.
    Post –qualification CriteriaPost–qualification Criteria 1.1. Average AnnualAverage Annual Construction turn-overConstruction turn-over 2.2. Availability of liquid assetsAvailability of liquid assets supplemented by projectsupplemented by project specific lines of Creditspecific lines of Credit 3.3. Experience in similarExperience in similar projectsprojects 4.4. Necessary Equipment.Necessary Equipment. 5.5. PersonnelPersonnel 6.6. Production rates of key itemsProduction rates of key items
  • 58.
    4. Bid Evaluation4.Bid Evaluation ReportReport
  • 59.

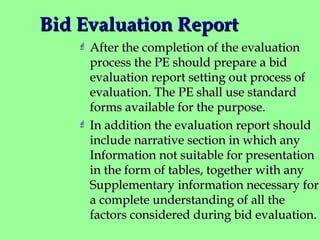

    Bid Evaluation ReportBidEvaluation Report  After the completion of the evaluationAfter the completion of the evaluation process the PE should prepare a bidprocess the PE should prepare a bid evaluation report setting out process ofevaluation report setting out process of evaluation. The PE shall use standardevaluation. The PE shall use standard forms available for the purpose.forms available for the purpose.  In addition the evaluation report shouldIn addition the evaluation report should include narrative section in which anyinclude narrative section in which any Information not suitable for presentationInformation not suitable for presentation in the form of tables, together with anyin the form of tables, together with any Supplementary information necessary forSupplementary information necessary for a complete understanding of all thea complete understanding of all the factors considered during bid evaluation.factors considered during bid evaluation.
  • 60.
