CO2 Transport for CCS:
     Global Potential &
      Local Challenges
          UKCCSC Winter School

               10th January 2012

          Harsh Pershad
              Element Energy Limited
            www.element-energy.co.uk
Introducing Element Energy

  Independent, impartial, UK-based low carbon energy technology consultancy.

  Mission is to help our clients make a successful transition to the low carbon
    economy.

  Clients include oil and gas majors, power companies, technology developers,
    national Governments, IEA, regional/local government, regulators, trade
    associations and NGOs.

  Use our expertise in appraising low carbon technologies, markets, business
    models, and regulations, to developing strategies for successful technology
    deployment.

  Majority (>75%) of work is repeat business from satisfied customers.

  Technologies covered include CCS, hydrogen, fuel cells, low carbon transport, low
    carbon buildings, energy masterplanning, energy efficiency, CHP, small scale
    renewables, microgeneration.                                                   2
Element Energy is a leading low carbon energy
consultancy offering services spanning from strategy
development to high end engineering solutions

                                                                                                    Low carbon
                                                                                                      power
       We operate in three     Low carbon transport                                                 generation
                                                              Low carbon buildings
            main sectors

                               •   EV scoping                       •    Master planning            • Carbon capture
                               •   H2 vehicles                      •    Building design              and storage
                               •   Infrastructure modelling         •    Policy advice              • Renewables
                               •   Business planning                •    Regional strategy          • Microgeneration
                                                                                                    • Techno-economics
                                                                                                    • Feasibility studies
                                                                                                    • Geographic data

       We offer three main                                                Strategy                        Engineering
                                        Due
     services to our clients         diligence                            & Policy                         Solutions

                               •   Technology assessments       •       Scenario planning           •   CFD
                               •   Market assessments           •       Techno-economic modelling   •   Software tools

                               •   Financial modelling          •       Business planning           •   Prototyping
                               •   Commercialisation advice     •       Stakeholder engagement      •   Installations

                                                                                                                            3

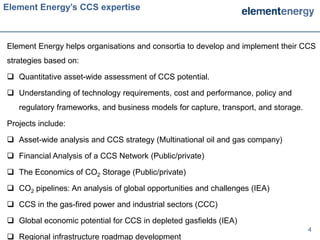

Element Energy’s CCS expertise

Element Energy helps organisations and consortia to develop and implement their CCS
strategies based on:

 Quantitative asset-wide assessment of CCS potential.

 Understanding of technology requirements, cost and performance, policy and
   regulatory frameworks, and business models for capture, transport, and storage.

Projects include:

 Asset-wide analysis and CCS strategy (Multinational oil and gas company)

 Financial Analysis of a CCS Network (Public/private)

 The Economics of CO2 Storage (Public/private)

 CO2 pipelines: An analysis of global opportunities and challenges (IEA)

 CCS in the gas-fired power and industrial sectors (CCC)

 Global economic potential for CCS in depleted gasfields (IEA)
                                                                                     4
 Regional infrastructure roadmap development
Outline

• Global CO2 pipeline potential

• North Sea CO2 transport scenarios

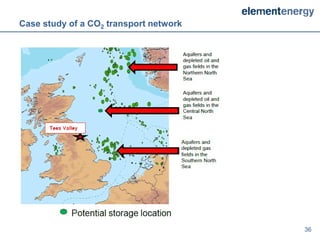

• Case study – developing a network in the Tees Valley

                                                         5

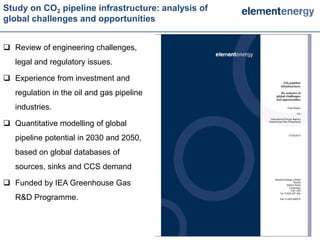

Study on CO2 pipeline infrastructure: analysis of
global challenges and opportunities

 Review of engineering challenges,
   legal and regulatory issues.

 Experience from investment and
   regulation in the oil and gas pipeline
   industries.

 Quantitative modelling of global
   pipeline potential in 2030 and 2050,
   based on global databases of
   sources, sinks and CCS demand

 Funded by IEA Greenhouse Gas
   R&D Programme.

                                                    6   6

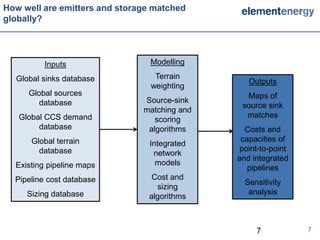

How well are emitters and storage matched
globally?

          Inputs                 Modelling

  Global sinks database           Terrain
                                                 Outputs
                                 weighting
     Global sources                             Maps of
        database               Source-sink
                                               source sink
                               matching and
   Global CCS demand                            matches
                                  scoring
        database                algorithms      Costs and
      Global terrain                           capacities of
                                Integrated
        database                               point-to-point
                                 network
                                              and integrated
  Existing pipeline maps          models
                                                 pipelines
  Pipeline cost database         Cost and
                                                Sensitivity
                                  sizing
     Sizing database                             analysis
                                algorithms

                                                   7            7

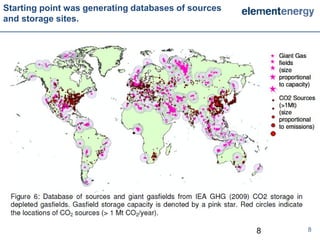

Starting point was generating databases of sources
and storage sites.

                                                     8   8

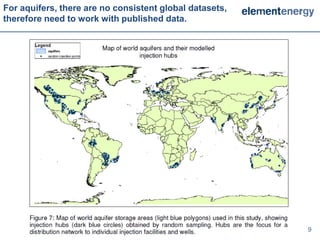

For aquifers, there are no consistent global datasets,
therefore need to work with published data.

                                                         9   9

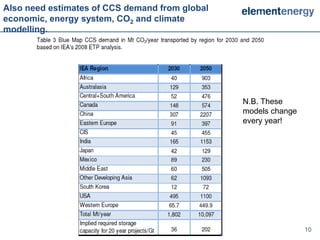

Also need estimates of CCS demand from global
economic, energy system, CO2 and climate
modelling.

                                                N.B. These
                                                models change
                                                every year!

                                                   10           10

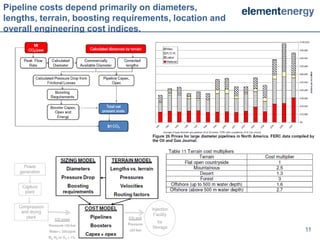

Pipeline costs depend primarily on diameters,
lengths, terrain, boosting requirements, location and
overall engineering cost indices.

                                                        11

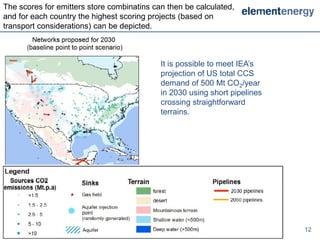

The scores for emitters store combinatins can then be calculated,
and for each country the highest scoring projects (based on
transport considerations) can be depicted.

                                            It is possible to meet IEA’s
                                            projection of US total CCS
                                            demand of 500 Mt CO2/year
                                            in 2030 using short pipelines
                                            crossing straightforward
                                            terrains.

                                                                       12   12

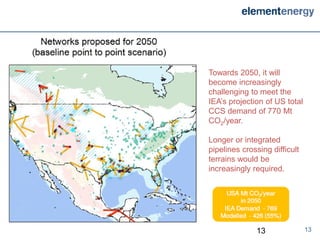

Towards 2050, it will
become increasingly
challenging to meet the
IEA’s projection of US total
CCS demand of 770 Mt
CO2/year.

Longer or integrated
pipelines crossing difficult
terrains would be
increasingly required.

              13               13

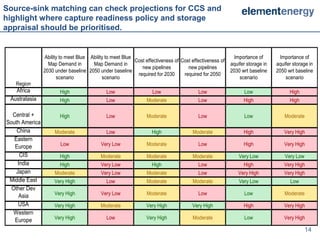

Source-sink matching can check projections for CCS and
highlight where capture readiness policy and storage
appraisal should be prioritised.

                Ability to meet Blue Ability to meet Blue                                                Importance of        Importance of
                                                          Cost effectiveness of Cost effectiveness of
                  Map Demand in       Map Demand in                                                     aquifer storage in   aquifer storage in
                                                             new pipelines         new pipelines
                2030 under baseline 2050 under baseline                                                 2030 wrt baseline    2050 wrt baseline
                                                           required for 2030     required for 2050
                      scenario             scenario                                                         scenario             scenario
   Region
   Africa              High                  Low                   Low                  Low                   Low                  High
 Australasia           High                  Low                Moderate                Low                   High                 High

  Central +            High                  Low                Moderate                Low                   Low                Moderate
South America
    China            Moderate                Low                  High                Moderate                High              Very High
   Eastern
   Europe              Low                 Very Low             Moderate                Low                   High              Very High

      CIS              High               Moderate              Moderate              Moderate              Very Low             Very Low
     India             High                Very Low               High                  Low                   High              Very High
    Japan            Moderate              Very Low             Moderate                Low                Very High            Very High
 Middle East         Very High               Low                Moderate              Moderate              Very Low               Low
  Other Dev
     Asia            Very High             Very Low             Moderate                Low                   Low                Moderate

     USA             Very High            Moderate              Very High            Very High                High              Very High
   Western
   Europe            Very High               Low                Very High             Moderate                Low               Very High

                                                                                                                                            14

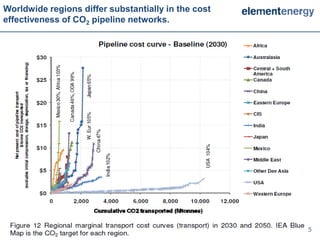

Worldwide regions differ substantially in the cost
effectiveness of CO2 pipeline networks.

                                                     15   15

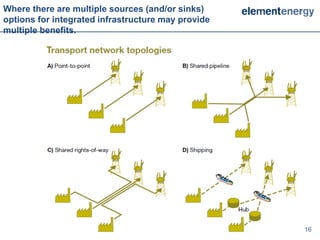

Where there are multiple sources (and/or sinks)
options for integrated infrastructure may provide
multiple benefits.

                                                    16   16

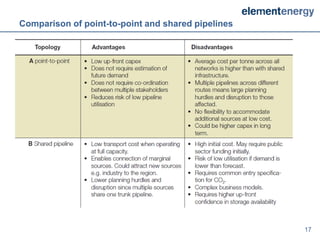

Comparison of point-to-point and shared pipelines

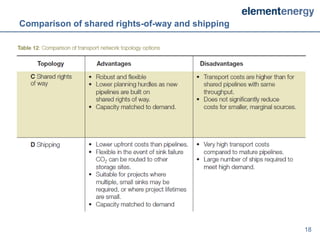

                                                    17
Comparison of shared rights-of-way and shipping

                                                  18

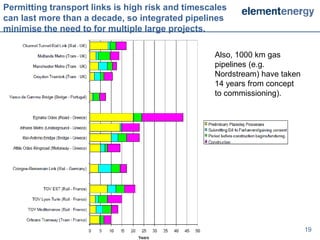

Permitting transport links is high risk and timescales
can last more than a decade, so integrated pipelines
minimise the need to for multiple large projects.

                                                   Also, 1000 km gas
                                                   pipelines (e.g.
                                                   Nordstream) have taken
                                                   14 years from concept
                                                   to commissioning).

                                                                            19

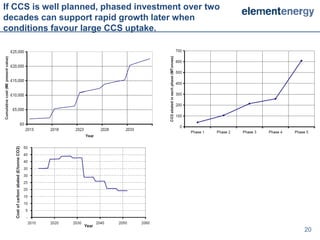

If CCS is well planned, phased investment over two
decades can support rapid growth later when
conditions favour large CCS uptake.

                                                     20

Outline

• Global CO2 pipeline potential

• North Sea CO2 transport scenarios

• Case study – developing a network in the Tees Valley

                                                         21

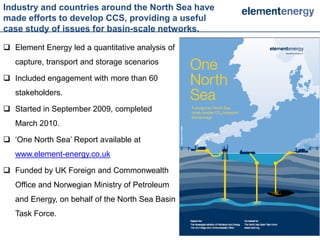

Industry and countries around the North Sea have
made efforts to develop CCS, providing a useful
case study of issues for basin-scale networks.

 Element Energy led a quantitative analysis of
   capture, transport and storage scenarios

 Included engagement with more than 60
   stakeholders.

 Started in September 2009, completed
   March 2010.

 ‘One North Sea’ Report available at
   www.element-energy.co.uk

 Funded by UK Foreign and Commonwealth
   Office and Norwegian Ministry of Petroleum
   and Energy, on behalf of the North Sea Basin
   Task Force.

                                                   22   22

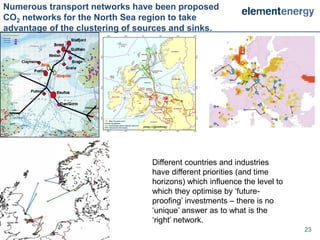

Numerous transport networks have been proposed
CO2 networks for the North Sea region to take
advantage of the clustering of sources and sinks.

                                 Different countries and industries
                                 have different priorities (and time
                                 horizons) which influence the level to
                                 which they optimise by ‘future-
                                 proofing’ investments – there is no
                                 ‘unique’ answer as to what is the
                                 ‘right’ network.
                                                                          23

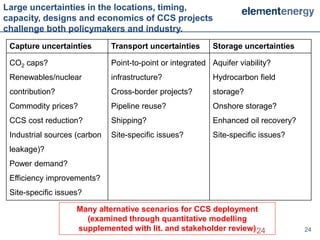

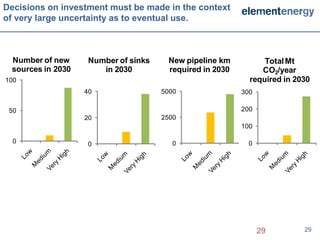

Large uncertainties in the locations, timing,
capacity, designs and economics of CCS projects
challenge both policymakers and industry.
 Capture uncertainties        Transport uncertainties      Storage uncertainties

 CO2 caps?                    Point-to-point or integrated Aquifer viability?
 Renewables/nuclear           infrastructure?              Hydrocarbon field
 contribution?                Cross-border projects?       storage?
 Commodity prices?            Pipeline reuse?              Onshore storage?
 CCS cost reduction?          Shipping?                    Enhanced oil recovery?
 Industrial sources (carbon   Site-specific issues?        Site-specific issues?
 leakage)?
 Power demand?
 Efficiency improvements?
 Site-specific issues?

                    Many alternative scenarios for CCS deployment
                      (examined through quantitative modelling
                    supplemented with lit. and stakeholder review) 24               24

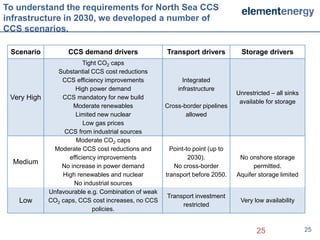

To understand the requirements for North Sea CCS
infrastructure in 2030, we developed a number of
CCS scenarios.

 Scenario          CCS demand drivers                Transport drivers           Storage drivers
                         Tight CO2 caps
                Substantial CCS cost reductions
                 CCS efficiency improvements               Integrated
                      High power demand                  infrastructure
                                                                               Unrestricted – all sinks
 Very High       CCS mandatory for new build
                                                                                available for storage
                     Moderate renewables             Cross-border pipelines
                      Limited new nuclear                   allowed
                         Low gas prices
                  CCS from industrial sources
                      Moderate CO2 caps
              Moderate CCS cost reductions and         Point-to point (up to
                   efficiency improvements                    2030).            No onshore storage
  Medium
                 No increase in power demand            No cross-border              permitted.
                 High renewables and nuclear         transport before 2050.    Aquifer storage limited
                     No industrial sources
             Unfavourable e.g. Combination of weak
                                                     Transport investment
   Low       CO2 caps, CCS cost increases, no CCS                               Very low availability
                                                          restricted
                            policies.

                                                                                      25                  25

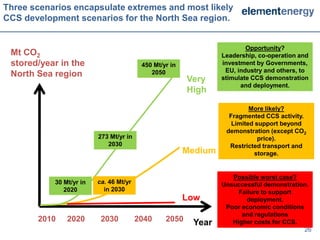

Three scenarios encapsulate extremes and most likely
CCS development scenarios for the North Sea region.

                                                                         Opportunity?
 Mt CO2                                                          Leadership, co-operation and
 stored/year in the                      450 Mt/yr in            investment by Governments,
                                                                  EU, industry and others, to
 North Sea region                           2050
                                                        Very     stimulate CCS demonstration
                                                                       and deployment.
                                                        High

                                                                          More likely?
                                                                   Fragmented CCS activity.
                                                                    Limited support beyond
                                                                  demonstration (except CO2
                         273 Mt/yr in                                        price).
                            2030                                   Restricted transport and
                                                        Medium              storage.

                                                                    Possible worst case?
           30 Mt/yr in   ca. 46 Mt/yr                            Unsuccessful demonstration.
              2020         in 2030                                    Failure to support
                                                        Low              deployment.
                                                                  Poor economic conditions
                                                                       and regulations
       2010    2020       2030          2040     2050    Year       Higher costs for CCS.
                                                                                           26

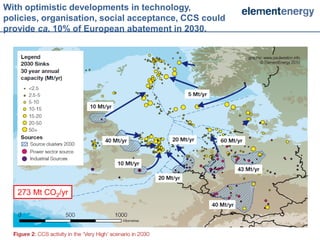

With optimistic developments in technology,
policies, organisation, social acceptance, CCS could
provide ca. 10% of European abatement in 2030.

   273 Mt CO2/yr

                                                       27   27

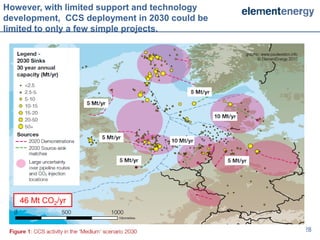

However, with limited support and technology
development, CCS deployment in 2030 could be
limited to only a few simple projects.

   46 Mt CO2/yr

                                               28   28
Decisions on investment must be made in the context
of very large uncertainty as to eventual use.

 Number of new      Number of sinks    New pipeline km          Total Mt
 sources in 2030       in 2030         required in 2030        CO2/year
100                                                         required in 2030
                   40                 5000                300

 50                                                       200
                   20                 2500
                                                          100

  0                 0                    0                  0

                                                                29        29
Very high CCS deployment could bring significant
economies of scale in transport costs.

                                    Marginal transport cost curve for 'Medium' and 'Very High' scenarios

                                        6

                                        5
                                                                                                      Very High
        Pipeline net present cost

                                                                                                      (integrated)
                                        4
                  €/tCO2

                                        3

                                        2                                                             Medium scenario

                                        1

                                        0
                                            0           100              200              300
                                                  Mt CO2/year transported in 2030

                          Cost represent the capital cost and operating costs (discounted at 10% over 30 years)
                                                 for new pipelines constructed in 2030.
                                  Costs exclude financing, capture, compression, boosting or storage.
                                                                                                       30               30
A combination of favourable drivers are required
to meet the highest demands (e.g. IEA roadmap
CCS demands).

                                                   31

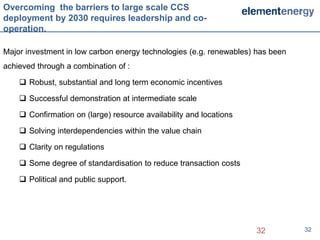

Overcoming the barriers to large scale CCS
deployment by 2030 requires leadership and co-
operation.

Major investment in low carbon energy technologies (e.g. renewables) has been
achieved through a combination of :

     Robust, substantial and long term economic incentives

     Successful demonstration at intermediate scale

     Confirmation on (large) resource availability and locations

     Solving interdependencies within the value chain

     Clarity on regulations

     Some degree of standardisation to reduce transaction costs

     Political and public support.

                                                                    32          32

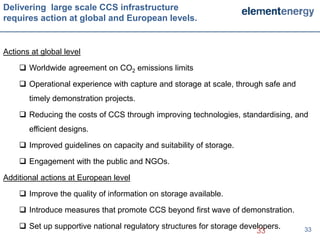

Delivering large scale CCS infrastructure
requires action at global and European levels.

Actions at global level

     Worldwide agreement on CO2 emissions limits

     Operational experience with capture and storage at scale, through safe and
       timely demonstration projects.

     Reducing the costs of CCS through improving technologies, standardising, and
       efficient designs.

     Improved guidelines on capacity and suitability of storage.

     Engagement with the public and NGOs.

Additional actions at European level

     Improve the quality of information on storage available.

     Introduce measures that promote CCS beyond first wave of demonstration.

     Set up supportive national regulatory structures for storage developers.
                                                                       33          33

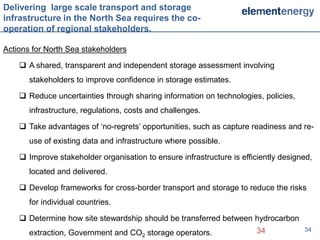

Delivering large scale transport and storage
infrastructure in the North Sea requires the co-
operation of regional stakeholders.

Actions for North Sea stakeholders

     A shared, transparent and independent storage assessment involving
       stakeholders to improve confidence in storage estimates.

     Reduce uncertainties through sharing information on technologies, policies,
       infrastructure, regulations, costs and challenges.

     Take advantages of ‘no-regrets’ opportunities, such as capture readiness and re-
       use of existing data and infrastructure where possible.

     Improve stakeholder organisation to ensure infrastructure is efficiently designed,
       located and delivered.

     Develop frameworks for cross-border transport and storage to reduce the risks
       for individual countries.

     Determine how site stewardship should be transferred between hydrocarbon
       extraction, Government and CO2 storage operators.                34           34
Outline

• Global CO2 pipeline potential

• North Sea CO2 transport scenarios

• Case study – developing a network in the Tees Valley

                                                         35
Case study of a CO2 transport network

                                        36

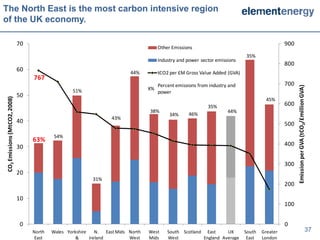

The North East is the most carbon intensive region
of the UK economy.

                              70                                                                                                                900
                                                                                        Other Emissions
                                                                                                                              35%
                                                                                        Industry and power sector emissions
                                                                                                                                                800
                              60                                           44%          tCO2 per £M Gross Value Added (GVA)
                                   767
                                                                                        Percent emissions from industry and                     700

                                                                                                                                                      Emission per GVA (tCO2/£million GVA)
                                                   51%                             X%
                                                                                        power
                              50
CO2 Emissions (MtCO2, 2008)

                                                                                                                                        45%
                                                                                                              35%                               600
                                                                                   38%                                 44%
                                                                                             34%     46%
                                                                   43%
                              40                                                                                                                500
                                            54%
                                   63%
                              30                                                                                                                400

                                                                                                                                                300
                              20
                                                            31%
                                                                                                                                                200

                              10
                                                                                                                                                100

                              0                                                                                                                 0
                                   North   Wales Yorkshire    N. East Mids North   West     South Scotland East     UK        South   Greater                                      37
                                   East              &     Ireland         West    Mids     West          England Average      East   London
Industry is partly insulated against the carbon price,
until at least 2020, but competitiveness will be
increasingly eroded.

                                             Total value at risk, EU ETS Phase III: (2012-20): £2.5 Bn
                                                    Total Annual Exposure to EU ETS: £306 M/yr
                               14
                                        £285 M/yr
                               12       7 Installations                                Purchase - auction or market

                                                                                       Free allocation
      Annual emissions (MtCO2/yr)

                               10
                                                                                       Outside scope of EU ETS

                                    8                      £12 M/yr
                                                          2 Installations

                                    6
                                                                               £7 M/yr
                                                                            13 Installations
                                    4
                                                                                                 £2 M/yr          £0 M/yr
                                                                                                6 Installations 6 Installations
                                    2                                                          (1 Food & drink)
                                                                                                (5 petroleum)

                                    0
                                           Power           Iron & Steel        Chemicals          Others       Biomass/Biofuels

                                                                               Sectors
                                                                                                                                  38

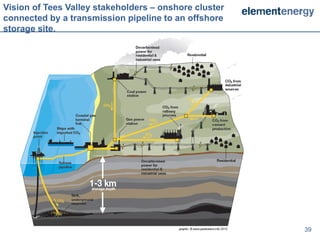

Vision of Tees Valley stakeholders – onshore cluster
connected by a transmission pipeline to an offshore
storage site.

                                                       39
Economic modelling of regional CCS network

                                             40

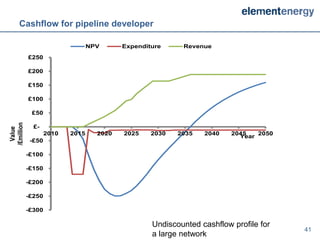

Cashflow for pipeline developer

                                  NPV      Expenditure     Revenue
            £250

            £200

            £150

            £100

             £50
/£million

              £-
  Value

                    2010   2015     2020   2025    2030   2035   2040    2045   2050
                                                                           Year
             -£50

            -£100

            -£150

            -£200

            -£250

            -£300

                                                   Undiscounted cashflow profile for
                                                                                       41
                                                   a large network

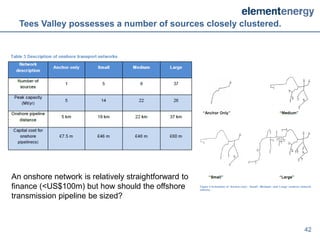

Tees Valley possesses a number of sources closely clustered.

An onshore network is relatively straightforward to
finance (<US$100m) but how should the offshore
transmission pipeline be sized?

                                                                 42
Because of economies of scale in pipelines, a single large
offshore pipeline provides the least cost if all users
connect, but requires upfront cost for over-sizing.

                                                             43

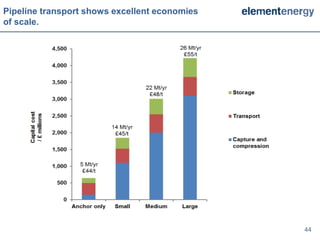

Pipeline transport shows excellent economies
of scale.

                                               44
The costs can be put in the context of the value of
businesses to the UK economy.

                                       Total GVA at risk, EU ETS Phase III (2012-20): £5.4 Bn
                                                Total Annual GVA at risk: £672 M/yr
                              500
                                                                £433 M/yr
                              450                               3,885 Jobs

                              400
  Gross value added (£M/yr)

                              350

                              300

                              250

                              200
                                                £121 M/yr
                              150                2,000 Jobs

                              100                                                           £59 M/yr
                                    £21 M/yr                                 £38 M/yr        330 Jobs
                              50     170 Jobs                                 535 Jobs

                               0
                                     Power       Iron & Steel   Chemicals     Others     Biomass/Biofuels

                                                                 Sectors
                                                                                                            45

CO2 pipeline network designs can be compared on
multiple key performance indicators.

                                                  Need to make
                                                  assumptions as to
                                                  growth in utilisation
                                                  over time.

                                                                          46

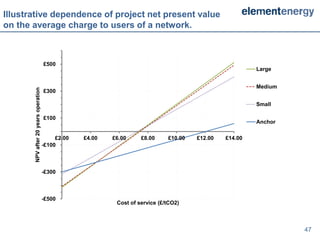

Illustrative dependence of project net present value
on the average charge to users of a network.

                                      £500
                                                                                                          Large

                                                                                                          Medium
       NPV after 20 years operation

                                      £300

                                                                                                          Small

                                      £100
                                                                                                          Anchor

                                           £2.00   £4.00   £6.00     £8.00     £10.00   £12.00   £14.00
                                      -£100

                                      -£300

                                      -£500
                                                            Cost of service (£/tCO2)

                                                                                                                   47
Pipeline economics are sensitive to multiple factors.

     Best and worse case can drive pipeline tariffs from £0/t to
     >£100/t CO2. (N.B. current CO2 prices in the ETS are 7        48
     Eur/t)

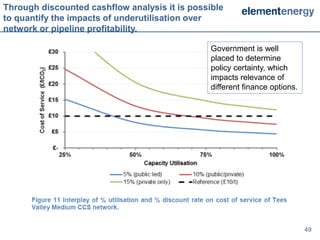

Through discounted cashflow analysis it is possible
to quantify the impacts of underutilisation over
network or pipeline profitability.

                                                Government is well
                                                placed to determine
                                                policy certainty, which
                                                impacts relevance of
                                                different finance options.

                                                                             49

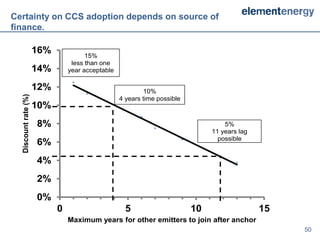

Certainty on CCS adoption depends on source of
finance.

                      16%             15%
                                 less than one
                      14%       year acceptable

                      12%                                 10%
  Discount rate (%)

                                                  4 years time possible
                      10%
                      8%                                                           5%
                                                                               11 years lag
                                                                                 possible
                      6%
                      4%
                      2%
                      0%
                            0                       5                     10                  15
                                Maximum years for other emitters to join after anchor
                                                                                                   50

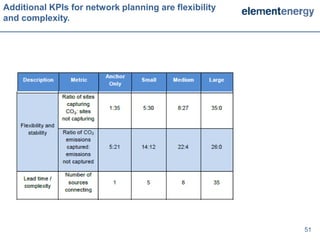

Additional KPIs for network planning are flexibility
and complexity.

                                                       51

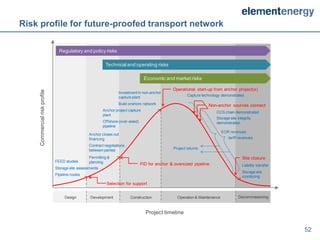

Risk profile for future-proofed transport network

                                Regulatory and policy risks

                                                          Technical and operating risks

                                                                                  Economic and market risks

                                                                                                 Operational start-up from anchor project(s)
    Commercial risk profile

                                                                  Investment in non-anchor
                                                                                                         Capture technology demonstrated
                                                                  capture plant
                                                                  Build onshore network                             Non-anchor sources connect
                                                         Anchor project capture
                                                                                                                         CCS chain demonstrated
                                                         plant
                                                                                                                         Storage site integrity
                                                         Offshore (over-sized)                                           demonstrated
                                                         pipeline
                                                                                                                             EOR revenues
                                                Anchor closes out
                                                financing                                                                       tariff revenues
                                                Contract negotiations
                                                between parties                                  Project returns

                                                Permitting &                                                                             Site closure
                              FEED studies      planning
                                                                                 FID for anchor & oversized pipeline                     Liability transfer
                              Storage site assessments
                                                                                                                                         Storage site
                              Pipeline routes                                                                                            monitoring
                                                           Selection for support

                                   Design        Development             Construction              Operation & Maintenance            Decommissioning

                                                                                   Project timeline

                                                                                                                                                              52
Possible organisation to deliver a future-proofed
transport network

                                                                                                                                              REGULATORY ISSUES
          EU support
          (NER 300)
                                                                         UK Government support                                                Capture permits; pipeline
                               Project selection                                                                                              RoW; storage & EOR
                                  and fund                                                                                                    permits; long-term liability
                                disbursement
                                                             CCS demo support                            CCS Levy
                                                             CCS Levy, CO2 price floors             CO2 price floors

                                                                              Initial MoU agreements

           Lenders                                 Anchor project(s)                                         Additional capture                            Lenders
                                                                                                                  sources              Loan
                                  Loan
                               agreements                                                                                           agreements
                                                                                Onshore network
                                                                                 owner/operator
                                                                                                       Tariff arrangements
                                                                                                       Equity & cost recovery
          Contractors                                                  Technical entry                 arrangements                                       Contractors
                                                                         specifications
                             Turnkey contract                                                                                     Turnkey contract
                               agreements                                                                                           agreements
                                                         Equity & cost                     CO2 supply and off-take
     Equipment procurement                                                                                                                           Equipment procurement
                                                         recovery                          agreements
          agreements                                                                                                                                      agreements
                                                         arrangements
                                                                                                                                   Performance
                              Performance                                       Offshore pipeline                                  guarantees
                              guarantees                                              SPV
      Equipment suppliers                                                                                                                             Equipment suppliers

                                Insurance                                                                       CO2 storage          Insurance
                                  policy           EOR operator(s)                                                                     policy
                                                                                                                operator(s)
                                                                            CO2 off-take agreements
           Insurers                                                                                                                                        Insurers

                                                                                                                                                                             53

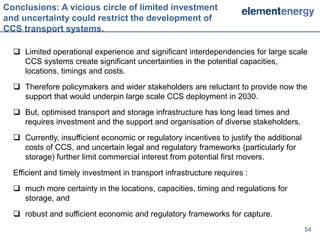

Conclusions: A vicious circle of limited investment
and uncertainty could restrict the development of
CCS transport systems.

   Limited operational experience and significant interdependencies for large scale
    CCS systems create significant uncertainties in the potential capacities,
    locations, timings and costs.
   Therefore policymakers and wider stakeholders are reluctant to provide now the
    support that would underpin large scale CCS deployment in 2030.
   But, optimised transport and storage infrastructure has long lead times and
    requires investment and the support and organisation of diverse stakeholders.
   Currently, insufficient economic or regulatory incentives to justify the additional
    costs of CCS, and uncertain legal and regulatory frameworks (particularly for
    storage) further limit commercial interest from potential first movers.
  Efficient and timely investment in transport infrastructure requires :
   much more certainty in the locations, capacities, timing and regulations for
    storage, and
   robust and sufficient economic and regulatory frameworks for capture.
                                                                                          54
Thank you for your attention.

       Feedback welcome to
Harsh.Pershad@element-energy.co.uk
          01223 852 496

                                     55

05 pershad ee_ccsc_cambridge - Early careers winter school, 9-12th January 2012, University of Cambridge

  • 1.
    CO2 Transport forCCS: Global Potential & Local Challenges UKCCSC Winter School 10th January 2012 Harsh Pershad Element Energy Limited www.element-energy.co.uk
  • 2.
    Introducing Element Energy  Independent, impartial, UK-based low carbon energy technology consultancy.  Mission is to help our clients make a successful transition to the low carbon economy.  Clients include oil and gas majors, power companies, technology developers, national Governments, IEA, regional/local government, regulators, trade associations and NGOs.  Use our expertise in appraising low carbon technologies, markets, business models, and regulations, to developing strategies for successful technology deployment.  Majority (>75%) of work is repeat business from satisfied customers.  Technologies covered include CCS, hydrogen, fuel cells, low carbon transport, low carbon buildings, energy masterplanning, energy efficiency, CHP, small scale renewables, microgeneration. 2
  • 3.
    Element Energy isa leading low carbon energy consultancy offering services spanning from strategy development to high end engineering solutions Low carbon power We operate in three Low carbon transport generation Low carbon buildings main sectors • EV scoping • Master planning • Carbon capture • H2 vehicles • Building design and storage • Infrastructure modelling • Policy advice • Renewables • Business planning • Regional strategy • Microgeneration • Techno-economics • Feasibility studies • Geographic data We offer three main Strategy Engineering Due services to our clients diligence & Policy Solutions • Technology assessments • Scenario planning • CFD • Market assessments • Techno-economic modelling • Software tools • Financial modelling • Business planning • Prototyping • Commercialisation advice • Stakeholder engagement • Installations 3
  • 4.
    Element Energy’s CCSexpertise Element Energy helps organisations and consortia to develop and implement their CCS strategies based on:  Quantitative asset-wide assessment of CCS potential.  Understanding of technology requirements, cost and performance, policy and regulatory frameworks, and business models for capture, transport, and storage. Projects include:  Asset-wide analysis and CCS strategy (Multinational oil and gas company)  Financial Analysis of a CCS Network (Public/private)  The Economics of CO2 Storage (Public/private)  CO2 pipelines: An analysis of global opportunities and challenges (IEA)  CCS in the gas-fired power and industrial sectors (CCC)  Global economic potential for CCS in depleted gasfields (IEA) 4  Regional infrastructure roadmap development
  • 5.
    Outline • Global CO2pipeline potential • North Sea CO2 transport scenarios • Case study – developing a network in the Tees Valley 5
  • 6.
    Study on CO2pipeline infrastructure: analysis of global challenges and opportunities  Review of engineering challenges, legal and regulatory issues.  Experience from investment and regulation in the oil and gas pipeline industries.  Quantitative modelling of global pipeline potential in 2030 and 2050, based on global databases of sources, sinks and CCS demand  Funded by IEA Greenhouse Gas R&D Programme. 6 6
  • 7.
    How well areemitters and storage matched globally? Inputs Modelling Global sinks database Terrain Outputs weighting Global sources Maps of database Source-sink source sink matching and Global CCS demand matches scoring database algorithms Costs and Global terrain capacities of Integrated database point-to-point network and integrated Existing pipeline maps models pipelines Pipeline cost database Cost and Sensitivity sizing Sizing database analysis algorithms 7 7
  • 8.
    Starting point wasgenerating databases of sources and storage sites. 8 8
  • 9.
    For aquifers, thereare no consistent global datasets, therefore need to work with published data. 9 9
  • 10.
    Also need estimatesof CCS demand from global economic, energy system, CO2 and climate modelling. N.B. These models change every year! 10 10
  • 11.
    Pipeline costs dependprimarily on diameters, lengths, terrain, boosting requirements, location and overall engineering cost indices. 11
  • 12.
    The scores foremitters store combinatins can then be calculated, and for each country the highest scoring projects (based on transport considerations) can be depicted. It is possible to meet IEA’s projection of US total CCS demand of 500 Mt CO2/year in 2030 using short pipelines crossing straightforward terrains. 12 12
  • 13.
    Towards 2050, itwill become increasingly challenging to meet the IEA’s projection of US total CCS demand of 770 Mt CO2/year. Longer or integrated pipelines crossing difficult terrains would be increasingly required. 13 13
  • 14.
    Source-sink matching cancheck projections for CCS and highlight where capture readiness policy and storage appraisal should be prioritised. Ability to meet Blue Ability to meet Blue Importance of Importance of Cost effectiveness of Cost effectiveness of Map Demand in Map Demand in aquifer storage in aquifer storage in new pipelines new pipelines 2030 under baseline 2050 under baseline 2030 wrt baseline 2050 wrt baseline required for 2030 required for 2050 scenario scenario scenario scenario Region Africa High Low Low Low Low High Australasia High Low Moderate Low High High Central + High Low Moderate Low Low Moderate South America China Moderate Low High Moderate High Very High Eastern Europe Low Very Low Moderate Low High Very High CIS High Moderate Moderate Moderate Very Low Very Low India High Very Low High Low High Very High Japan Moderate Very Low Moderate Low Very High Very High Middle East Very High Low Moderate Moderate Very Low Low Other Dev Asia Very High Very Low Moderate Low Low Moderate USA Very High Moderate Very High Very High High Very High Western Europe Very High Low Very High Moderate Low Very High 14
  • 15.
    Worldwide regions differsubstantially in the cost effectiveness of CO2 pipeline networks. 15 15
  • 16.
    Where there aremultiple sources (and/or sinks) options for integrated infrastructure may provide multiple benefits. 16 16
  • 17.
    Comparison of point-to-pointand shared pipelines 17
  • 18.
    Comparison of sharedrights-of-way and shipping 18
  • 19.
    Permitting transport linksis high risk and timescales can last more than a decade, so integrated pipelines minimise the need to for multiple large projects. Also, 1000 km gas pipelines (e.g. Nordstream) have taken 14 years from concept to commissioning). 19
  • 20.
    If CCS iswell planned, phased investment over two decades can support rapid growth later when conditions favour large CCS uptake. 20
  • 21.
    Outline • Global CO2pipeline potential • North Sea CO2 transport scenarios • Case study – developing a network in the Tees Valley 21
  • 22.
    Industry and countriesaround the North Sea have made efforts to develop CCS, providing a useful case study of issues for basin-scale networks.  Element Energy led a quantitative analysis of capture, transport and storage scenarios  Included engagement with more than 60 stakeholders.  Started in September 2009, completed March 2010.  ‘One North Sea’ Report available at www.element-energy.co.uk  Funded by UK Foreign and Commonwealth Office and Norwegian Ministry of Petroleum and Energy, on behalf of the North Sea Basin Task Force. 22 22
  • 23.
    Numerous transport networkshave been proposed CO2 networks for the North Sea region to take advantage of the clustering of sources and sinks. Different countries and industries have different priorities (and time horizons) which influence the level to which they optimise by ‘future- proofing’ investments – there is no ‘unique’ answer as to what is the ‘right’ network. 23
  • 24.
    Large uncertainties inthe locations, timing, capacity, designs and economics of CCS projects challenge both policymakers and industry. Capture uncertainties Transport uncertainties Storage uncertainties CO2 caps? Point-to-point or integrated Aquifer viability? Renewables/nuclear infrastructure? Hydrocarbon field contribution? Cross-border projects? storage? Commodity prices? Pipeline reuse? Onshore storage? CCS cost reduction? Shipping? Enhanced oil recovery? Industrial sources (carbon Site-specific issues? Site-specific issues? leakage)? Power demand? Efficiency improvements? Site-specific issues? Many alternative scenarios for CCS deployment (examined through quantitative modelling supplemented with lit. and stakeholder review) 24 24
  • 25.
    To understand therequirements for North Sea CCS infrastructure in 2030, we developed a number of CCS scenarios. Scenario CCS demand drivers Transport drivers Storage drivers Tight CO2 caps Substantial CCS cost reductions CCS efficiency improvements Integrated High power demand infrastructure Unrestricted – all sinks Very High CCS mandatory for new build available for storage Moderate renewables Cross-border pipelines Limited new nuclear allowed Low gas prices CCS from industrial sources Moderate CO2 caps Moderate CCS cost reductions and Point-to point (up to efficiency improvements 2030). No onshore storage Medium No increase in power demand No cross-border permitted. High renewables and nuclear transport before 2050. Aquifer storage limited No industrial sources Unfavourable e.g. Combination of weak Transport investment Low CO2 caps, CCS cost increases, no CCS Very low availability restricted policies. 25 25
  • 26.
    Three scenarios encapsulateextremes and most likely CCS development scenarios for the North Sea region. Opportunity? Mt CO2 Leadership, co-operation and stored/year in the 450 Mt/yr in investment by Governments, EU, industry and others, to North Sea region 2050 Very stimulate CCS demonstration and deployment. High More likely? Fragmented CCS activity. Limited support beyond demonstration (except CO2 273 Mt/yr in price). 2030 Restricted transport and Medium storage. Possible worst case? 30 Mt/yr in ca. 46 Mt/yr Unsuccessful demonstration. 2020 in 2030 Failure to support Low deployment. Poor economic conditions and regulations 2010 2020 2030 2040 2050 Year Higher costs for CCS. 26
  • 27.
    With optimistic developmentsin technology, policies, organisation, social acceptance, CCS could provide ca. 10% of European abatement in 2030. 273 Mt CO2/yr 27 27
  • 28.
    However, with limitedsupport and technology development, CCS deployment in 2030 could be limited to only a few simple projects. 46 Mt CO2/yr 28 28
  • 29.
    Decisions on investmentmust be made in the context of very large uncertainty as to eventual use. Number of new Number of sinks New pipeline km Total Mt sources in 2030 in 2030 required in 2030 CO2/year 100 required in 2030 40 5000 300 50 200 20 2500 100 0 0 0 0 29 29
  • 30.
    Very high CCSdeployment could bring significant economies of scale in transport costs. Marginal transport cost curve for 'Medium' and 'Very High' scenarios 6 5 Very High Pipeline net present cost (integrated) 4 €/tCO2 3 2 Medium scenario 1 0 0 100 200 300 Mt CO2/year transported in 2030 Cost represent the capital cost and operating costs (discounted at 10% over 30 years) for new pipelines constructed in 2030. Costs exclude financing, capture, compression, boosting or storage. 30 30
  • 31.
    A combination offavourable drivers are required to meet the highest demands (e.g. IEA roadmap CCS demands). 31
  • 32.
    Overcoming the barriersto large scale CCS deployment by 2030 requires leadership and co- operation. Major investment in low carbon energy technologies (e.g. renewables) has been achieved through a combination of :  Robust, substantial and long term economic incentives  Successful demonstration at intermediate scale  Confirmation on (large) resource availability and locations  Solving interdependencies within the value chain  Clarity on regulations  Some degree of standardisation to reduce transaction costs  Political and public support. 32 32
  • 33.
    Delivering large scaleCCS infrastructure requires action at global and European levels. Actions at global level  Worldwide agreement on CO2 emissions limits  Operational experience with capture and storage at scale, through safe and timely demonstration projects.  Reducing the costs of CCS through improving technologies, standardising, and efficient designs.  Improved guidelines on capacity and suitability of storage.  Engagement with the public and NGOs. Additional actions at European level  Improve the quality of information on storage available.  Introduce measures that promote CCS beyond first wave of demonstration.  Set up supportive national regulatory structures for storage developers. 33 33
  • 34.
    Delivering large scaletransport and storage infrastructure in the North Sea requires the co- operation of regional stakeholders. Actions for North Sea stakeholders  A shared, transparent and independent storage assessment involving stakeholders to improve confidence in storage estimates.  Reduce uncertainties through sharing information on technologies, policies, infrastructure, regulations, costs and challenges.  Take advantages of ‘no-regrets’ opportunities, such as capture readiness and re- use of existing data and infrastructure where possible.  Improve stakeholder organisation to ensure infrastructure is efficiently designed, located and delivered.  Develop frameworks for cross-border transport and storage to reduce the risks for individual countries.  Determine how site stewardship should be transferred between hydrocarbon extraction, Government and CO2 storage operators. 34 34
  • 35.
    Outline • Global CO2pipeline potential • North Sea CO2 transport scenarios • Case study – developing a network in the Tees Valley 35
  • 36.
    Case study ofa CO2 transport network 36
  • 37.
    The North Eastis the most carbon intensive region of the UK economy. 70 900 Other Emissions 35% Industry and power sector emissions 800 60 44% tCO2 per £M Gross Value Added (GVA) 767 Percent emissions from industry and 700 Emission per GVA (tCO2/£million GVA) 51% X% power 50 CO2 Emissions (MtCO2, 2008) 45% 35% 600 38% 44% 34% 46% 43% 40 500 54% 63% 30 400 300 20 31% 200 10 100 0 0 North Wales Yorkshire N. East Mids North West South Scotland East UK South Greater 37 East & Ireland West Mids West England Average East London
  • 38.
    Industry is partlyinsulated against the carbon price, until at least 2020, but competitiveness will be increasingly eroded. Total value at risk, EU ETS Phase III: (2012-20): £2.5 Bn Total Annual Exposure to EU ETS: £306 M/yr 14 £285 M/yr 12 7 Installations Purchase - auction or market Free allocation Annual emissions (MtCO2/yr) 10 Outside scope of EU ETS 8 £12 M/yr 2 Installations 6 £7 M/yr 13 Installations 4 £2 M/yr £0 M/yr 6 Installations 6 Installations 2 (1 Food & drink) (5 petroleum) 0 Power Iron & Steel Chemicals Others Biomass/Biofuels Sectors 38
  • 39.
    Vision of TeesValley stakeholders – onshore cluster connected by a transmission pipeline to an offshore storage site. 39
  • 40.
    Economic modelling ofregional CCS network 40
  • 41.
    Cashflow for pipelinedeveloper NPV Expenditure Revenue £250 £200 £150 £100 £50 /£million £- Value 2010 2015 2020 2025 2030 2035 2040 2045 2050 Year -£50 -£100 -£150 -£200 -£250 -£300 Undiscounted cashflow profile for 41 a large network
  • 42.
    Tees Valley possessesa number of sources closely clustered. An onshore network is relatively straightforward to finance (<US$100m) but how should the offshore transmission pipeline be sized? 42
  • 43.
    Because of economiesof scale in pipelines, a single large offshore pipeline provides the least cost if all users connect, but requires upfront cost for over-sizing. 43
  • 44.
    Pipeline transport showsexcellent economies of scale. 44
  • 45.
    The costs canbe put in the context of the value of businesses to the UK economy. Total GVA at risk, EU ETS Phase III (2012-20): £5.4 Bn Total Annual GVA at risk: £672 M/yr 500 £433 M/yr 450 3,885 Jobs 400 Gross value added (£M/yr) 350 300 250 200 £121 M/yr 150 2,000 Jobs 100 £59 M/yr £21 M/yr £38 M/yr 330 Jobs 50 170 Jobs 535 Jobs 0 Power Iron & Steel Chemicals Others Biomass/Biofuels Sectors 45
  • 46.
    CO2 pipeline networkdesigns can be compared on multiple key performance indicators. Need to make assumptions as to growth in utilisation over time. 46
  • 47.
    Illustrative dependence ofproject net present value on the average charge to users of a network. £500 Large Medium NPV after 20 years operation £300 Small £100 Anchor £2.00 £4.00 £6.00 £8.00 £10.00 £12.00 £14.00 -£100 -£300 -£500 Cost of service (£/tCO2) 47
  • 48.
    Pipeline economics aresensitive to multiple factors. Best and worse case can drive pipeline tariffs from £0/t to >£100/t CO2. (N.B. current CO2 prices in the ETS are 7 48 Eur/t)
  • 49.
    Through discounted cashflowanalysis it is possible to quantify the impacts of underutilisation over network or pipeline profitability. Government is well placed to determine policy certainty, which impacts relevance of different finance options. 49
  • 50.
    Certainty on CCSadoption depends on source of finance. 16% 15% less than one 14% year acceptable 12% 10% Discount rate (%) 4 years time possible 10% 8% 5% 11 years lag possible 6% 4% 2% 0% 0 5 10 15 Maximum years for other emitters to join after anchor 50
  • 51.
    Additional KPIs fornetwork planning are flexibility and complexity. 51
  • 52.
    Risk profile forfuture-proofed transport network Regulatory and policy risks Technical and operating risks Economic and market risks Operational start-up from anchor project(s) Commercial risk profile Investment in non-anchor Capture technology demonstrated capture plant Build onshore network Non-anchor sources connect Anchor project capture CCS chain demonstrated plant Storage site integrity Offshore (over-sized) demonstrated pipeline EOR revenues Anchor closes out financing tariff revenues Contract negotiations between parties Project returns Permitting & Site closure FEED studies planning FID for anchor & oversized pipeline Liability transfer Storage site assessments Storage site Pipeline routes monitoring Selection for support Design Development Construction Operation & Maintenance Decommissioning Project timeline 52
  • 53.
    Possible organisation todeliver a future-proofed transport network REGULATORY ISSUES EU support (NER 300) UK Government support Capture permits; pipeline Project selection RoW; storage & EOR and fund permits; long-term liability disbursement CCS demo support CCS Levy CCS Levy, CO2 price floors CO2 price floors Initial MoU agreements Lenders Anchor project(s) Additional capture Lenders sources Loan Loan agreements agreements Onshore network owner/operator Tariff arrangements Equity & cost recovery Contractors Technical entry arrangements Contractors specifications Turnkey contract Turnkey contract agreements agreements Equity & cost CO2 supply and off-take Equipment procurement Equipment procurement recovery agreements agreements agreements arrangements Performance Performance Offshore pipeline guarantees guarantees SPV Equipment suppliers Equipment suppliers Insurance CO2 storage Insurance policy EOR operator(s) policy operator(s) CO2 off-take agreements Insurers Insurers 53
  • 54.
    Conclusions: A viciouscircle of limited investment and uncertainty could restrict the development of CCS transport systems.  Limited operational experience and significant interdependencies for large scale CCS systems create significant uncertainties in the potential capacities, locations, timings and costs.  Therefore policymakers and wider stakeholders are reluctant to provide now the support that would underpin large scale CCS deployment in 2030.  But, optimised transport and storage infrastructure has long lead times and requires investment and the support and organisation of diverse stakeholders.  Currently, insufficient economic or regulatory incentives to justify the additional costs of CCS, and uncertain legal and regulatory frameworks (particularly for storage) further limit commercial interest from potential first movers. Efficient and timely investment in transport infrastructure requires :  much more certainty in the locations, capacities, timing and regulations for storage, and  robust and sufficient economic and regulatory frameworks for capture. 54
  • 55.
    Thank you foryour attention. Feedback welcome to Harsh.Pershad@element-energy.co.uk 01223 852 496 55
