The Wellesley 2025 stakeholders and planners proactive plan for campus renewal provides a working model for the presentation in which we identify goals and objectives and share initiatives, solutions, analysis ,and economic factors that affect construction Market forecasting, and project cost multipliers for master planning projects.
In response to traffic congestion on St Clair Avenue West around Keele Street and Old Weston Road, City Council has directed staff to carry out an Environmental Assessment (EA) Study of the St. Clair Avenue / Rail Crossing between Keele Street and Old Weston Road. This project will investigate solutions to the traffic concerns in this area
In response to traffic congestion on St Clair Avenue West around Keele Street and Old Weston Road, City Council has directed staff to carry out an Environmental Assessment (EA) Study of the St. Clair Avenue / Rail Crossing between Keele Street and Old Weston Road. This project will investigate solutions to the traffic concerns in this area
RIAA recently released their report on recorded music revenues and shipment information for 2014. The report includes data on key music formats like digital downloads, subscriptions and streaming plus CDs, vinyl and more. During Music Biz 2015 in Nashville on May 12, RIAA’s VP Research and Strategic Analysis, Josh Friedlander presented the data highlights and diving deeper into the report.
CA Higher Education Sustainability Conference 2010Rob Barthelman
2010 California Higher Education Sustainability Conference, Designing the Best Environments for Humans by Rob Barthelman, V-Anne Chernock, and Hormoz Janssens
Backlog, Deferred Maintenance and its use in PlanningSightlines
Gina Matsoukas presents on putting a process in place that will help you turn granular details of your backlog of needs into a strategic action plan for your campus.
New strategies for attacking deferred maintenance december 2012Sightlines
Learn how national data trends show campus buildings are aging and campus backlogs are growing. And, that these trends will accelerate over the next ten years as building constructed in the 1960's turn 50 years old and capital funding from all sources continue to be limited.
Furthermore, learn how the partnership between Sightlines, LLC and University of Massachusetts - Amherst that began in 2005 resulted in more refined documented building conditions, creation of portfolios of projects, and engaged campus leadership in a priority setting process to reach consensus on a multi-year capital plan through the Integrated Facilities Planning process.
Brian Yolitz, MnSCU Associate Vice Chancellor of Facilities
This presentation will focus on and answer questions about the MnSCU system’s legislative capital bonding request.
AIA 2013: Facts on the Ground: Testing the Performance of Ft. Carson's Green ...Shanti Pless
Our AIA 2013 Ft. Carson GSA High Performance Buildings Demonstration Results. Full site with Executive summary and full report at: http://www.gsa.gov/portal/content/195803
RIAA recently released their report on recorded music revenues and shipment information for 2014. The report includes data on key music formats like digital downloads, subscriptions and streaming plus CDs, vinyl and more. During Music Biz 2015 in Nashville on May 12, RIAA’s VP Research and Strategic Analysis, Josh Friedlander presented the data highlights and diving deeper into the report.
CA Higher Education Sustainability Conference 2010Rob Barthelman
2010 California Higher Education Sustainability Conference, Designing the Best Environments for Humans by Rob Barthelman, V-Anne Chernock, and Hormoz Janssens
Backlog, Deferred Maintenance and its use in PlanningSightlines
Gina Matsoukas presents on putting a process in place that will help you turn granular details of your backlog of needs into a strategic action plan for your campus.
New strategies for attacking deferred maintenance december 2012Sightlines
Learn how national data trends show campus buildings are aging and campus backlogs are growing. And, that these trends will accelerate over the next ten years as building constructed in the 1960's turn 50 years old and capital funding from all sources continue to be limited.
Furthermore, learn how the partnership between Sightlines, LLC and University of Massachusetts - Amherst that began in 2005 resulted in more refined documented building conditions, creation of portfolios of projects, and engaged campus leadership in a priority setting process to reach consensus on a multi-year capital plan through the Integrated Facilities Planning process.
Brian Yolitz, MnSCU Associate Vice Chancellor of Facilities
This presentation will focus on and answer questions about the MnSCU system’s legislative capital bonding request.
AIA 2013: Facts on the Ground: Testing the Performance of Ft. Carson's Green ...Shanti Pless
Our AIA 2013 Ft. Carson GSA High Performance Buildings Demonstration Results. Full site with Executive summary and full report at: http://www.gsa.gov/portal/content/195803
Strategic Renewable Energy Planning on Campus
Part of a workshop presented by Mieko A Ozeki, University of Vermont
This workshop will share lessons learned from two public institutions, University of Connecticut and the University of Vermont, that carried out comprehensive renewable energy feasibility studies and renewable energy plans on their respective campuses. Participants will break up into small groups to brainstorm ideas to implement a renewable energy and microgrid plan, and mindmap how these ideas can be tied to research, co-curricular education activities, green job opportunities, operations, and climate action planning on their respective campuses.
This is a presentation by Dada Robert in a Your Skill Boost masterclass organised by the Excellence Foundation for South Sudan (EFSS) on Saturday, the 25th and Sunday, the 26th of May 2024.
He discussed the concept of quality improvement, emphasizing its applicability to various aspects of life, including personal, project, and program improvements. He defined quality as doing the right thing at the right time in the right way to achieve the best possible results and discussed the concept of the "gap" between what we know and what we do, and how this gap represents the areas we need to improve. He explained the scientific approach to quality improvement, which involves systematic performance analysis, testing and learning, and implementing change ideas. He also highlighted the importance of client focus and a team approach to quality improvement.
Students, digital devices and success - Andreas Schleicher - 27 May 2024..pptxEduSkills OECD
Andreas Schleicher presents at the OECD webinar ‘Digital devices in schools: detrimental distraction or secret to success?’ on 27 May 2024. The presentation was based on findings from PISA 2022 results and the webinar helped launch the PISA in Focus ‘Managing screen time: How to protect and equip students against distraction’ https://www.oecd-ilibrary.org/education/managing-screen-time_7c225af4-en and the OECD Education Policy Perspective ‘Students, digital devices and success’ can be found here - https://oe.cd/il/5yV
We all have good and bad thoughts from time to time and situation to situation. We are bombarded daily with spiraling thoughts(both negative and positive) creating all-consuming feel , making us difficult to manage with associated suffering. Good thoughts are like our Mob Signal (Positive thought) amidst noise(negative thought) in the atmosphere. Negative thoughts like noise outweigh positive thoughts. These thoughts often create unwanted confusion, trouble, stress and frustration in our mind as well as chaos in our physical world. Negative thoughts are also known as “distorted thinking”.
Ethnobotany and Ethnopharmacology:
Ethnobotany in herbal drug evaluation,
Impact of Ethnobotany in traditional medicine,
New development in herbals,
Bio-prospecting tools for drug discovery,
Role of Ethnopharmacology in drug evaluation,
Reverse Pharmacology.
Operation “Blue Star” is the only event in the history of Independent India where the state went into war with its own people. Even after about 40 years it is not clear if it was culmination of states anger over people of the region, a political game of power or start of dictatorial chapter in the democratic setup.
The people of Punjab felt alienated from main stream due to denial of their just demands during a long democratic struggle since independence. As it happen all over the word, it led to militant struggle with great loss of lives of military, police and civilian personnel. Killing of Indira Gandhi and massacre of innocent Sikhs in Delhi and other India cities was also associated with this movement.
Unit 8 - Information and Communication Technology (Paper I).pdfThiyagu K
This slides describes the basic concepts of ICT, basics of Email, Emerging Technology and Digital Initiatives in Education. This presentations aligns with the UGC Paper I syllabus.
Digital Tools and AI for Teaching Learning and Research
Wellesley 2025 Presentation
1. Wellesley Campus Renewal
Master Planning: A Better Way?
Since 1972
Jon Alvarez, AIA, NCARB - Capital Program Director, Aramark Engineering Solutions
James Vermeulen, PQS, LEED AP – Co CEO, Vermeulens
Melissa Chabot, LEED AP – Project Manager, Vermeulens
North America’s Construction Economists Vermeulens.com
B o s t o n T o r o n t o D a l l a s D e n v e r L o s A n g e l e s
®
Service Beyond Estimation
2. 2
AIA Continuing Education
Vermeulens is a Registered Provider with The American Institute of Architects
Continuing Education Systems. Credit earned on completion of this program
will be reported to CES Records for AIA members. Certificates of Completion
for non-AIA members are available on request.
This program is registered with the AIA/CES for continuing professional
education. As such, it does not include content that may be deemed or
construed to be an approval or endorsement by the AIA of any material of
construction or any method or manner of handling, using, distributing, or
dealing in any material or product. Questions related to specific materials,
methods, and services will be addressed at the conclusion of this
presentation.
N o r t h A m e r i c a ’ s C o n s t r u c t i o n E c o n o m i s t
Wellesley Campus Renewal
3. 3
Learning Objectives
B o s t o n T o r o n t o D a l l a s D e n v e r L o s A n g e l e s

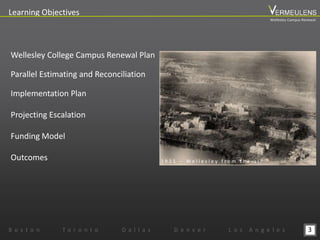

Wellesley College Campus Renewal Plan
Parallel Estimating and Reconciliation
Implementation Plan
Projecting Escalation
Funding Model
Outcomes 1 9 2 1 – W e l l e s l e y f r o m t h e a i r
Wellesley Campus Renewal
4. 4

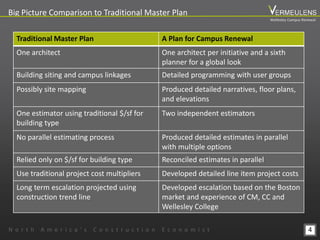

Big Picture Comparison to Traditional Master Plan
N o r t h A m e r i c a ’ s C o n s t r u c t i o n E c o n o m i s t
Traditional Master Plan A Plan for Campus Renewal
One architect One architect per initiative and a sixth
planner for a global look
Building siting and campus linkages Detailed programming with user groups
Possibly site mapping Produced detailed narratives, floor plans,
and elevations
One estimator using traditional $/sf for
building type
Two independent estimators
No parallel estimating process Produced detailed estimates in parallel
with multiple options
Relied only on $/sf for building type Reconciled estimates in parallel
Use traditional project cost multipliers Developed detailed line item project costs
Long term escalation projected using
construction trend line
Developed escalation based on the Boston
market and experience of CM, CC and
Wellesley College
Wellesley Campus Renewal
5. 5
Wellesley College, Wellesley, MA
B o s t o n T o r o n t o D a l l a s D e n v e r L o s A n g e l e s
Private, independent, four-year, liberal
arts college for women founded in 1870
Mission to provide a liberal
arts education, “for women who will
make a difference in the world”
One of the most academically
challenging, and diverse colleges in the
country
1 9 3 4 – B e e b e F r e s h m e n
Wellesley Campus Renewal
6. 6

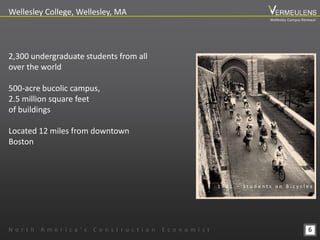

Wellesley College, Wellesley, MA
N o r t h A m e r i c a ’ s C o n s t r u c t i o n E c o n o m i s t
2,300 undergraduate students from all
over the world
500-acre bucolic campus,
2.5 million square feet
of buildings
Located 12 miles from downtown
Boston
1 9 3 1 – S t u d e n t s o n B i c y c l e s
Wellesley Campus Renewal
7. 7

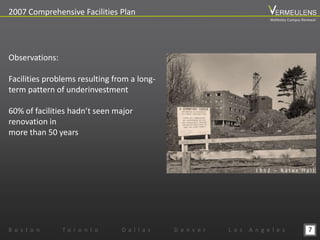

2007 Comprehensive Facilities Plan
B o s t o n T o r o n t o D a l l a s D e n v e r L o s A n g e l e s
Observations:
Facilities problems resulting from a long-
term pattern of underinvestment
60% of facilities hadn’t seen major
renovation in
more than 50 years
1 9 5 2 – B a t e s H a l l
Wellesley Campus Renewal
8. 8

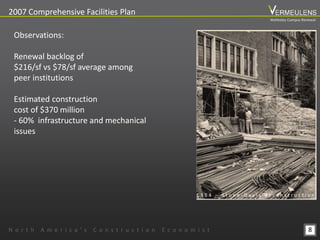

2007 Comprehensive Facilities Plan
N o r t h A m e r i c a ’ s C o n s t r u c t i o n E c o n o m i s t
Observations:
Renewal backlog of
$216/sf vs $78/sf average among
peer institutions
Estimated construction
cost of $370 million
- 60% infrastructure and mechanical
issues
1 9 6 4 – S t o n e - D a v i s R e c o n s t r u c t i o n
Wellesley Campus Renewal
9. 9
2007 Comprehensive Facilities Plan
B o s t o n T o r o n t o D a l l a s D e n v e r L o s A n g e l e s

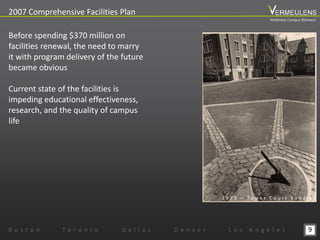

Before spending $370 million on
facilities renewal, the need to marry
it with program delivery of the future
became obvious
Current state of the facilities is
impeding educational effectiveness,
research, and the quality of campus
life
1 9 7 3 – T o w e r C o u r t S u n d i a l
Wellesley Campus Renewal
10. 10
2010 Program Planning Initiative was Born
N o r t h A m e r i c a ’ s C o n s t r u c t i o n E c o n o m i s t
President and Board of Trustees decided to significantly increase the
allocation to campus renewal
Program issues to drive planning
Wellesley Campus Renewal
11. 11

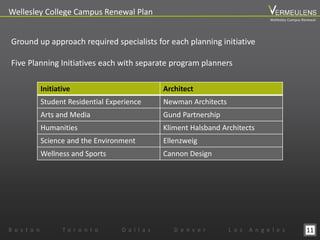

Wellesley College Campus Renewal Plan
B o s t o n T o r o n t o D a l l a s D e n v e r L o s A n g e l e s
Ground up approach required specialists for each planning initiative
Five Planning Initiatives each with separate program planners
Initiative Architect
Student Residential Experience Newman Architects
Arts and Media Gund Partnership
Humanities Kliment Halsband Architects
Science and the Environment Ellenzweig
Wellness and Sports Cannon Design
Wellesley Campus Renewal
12. 12
Wellesley College Campus Renewal Plan
N o r t h A m e r i c a ’ s C o n s t r u c t i o n E c o n o m i s t

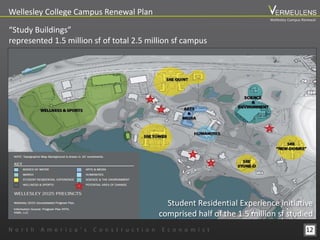

“Study Buildings”
represented 1.5 million sf of total 2.5 million sf campus
Student Residential Experience initiative
comprised half of the 1.5 million sf studied
Wellesley Campus Renewal
13. 13

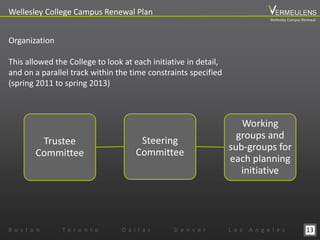

Wellesley College Campus Renewal Plan
B o s t o n T o r o n t o D a l l a s D e n v e r L o s A n g e l e s
Organization
This allowed the College to look at each initiative in detail,
and on a parallel track within the time constraints specified
(spring 2011 to spring 2013)
Trustee
Committee
Steering
Committee
Working
groups and
sub-groups for
each planning
initiative
Wellesley Campus Renewal
14. 14

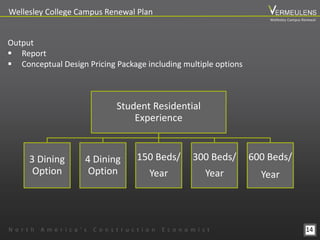

Wellesley College Campus Renewal Plan
N o r t h A m e r i c a ’ s C o n s t r u c t i o n E c o n o m i s t
Output
Report
Conceptual Design Pricing Package including multiple options
Student Residential
Experience
3 Dining
Option
4 Dining
Option
150 Beds/
Year
300 Beds/
Year
600 Beds/
Year
Wellesley Campus Renewal
15. 15
Wellesley College Campus Renewal Plan
B o s t o n T o r o n t o D a l l a s D e n v e r L o s A n g e l e s

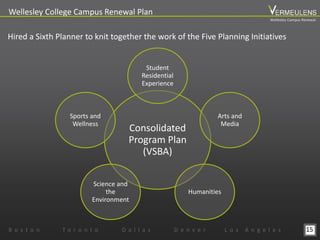

Hired a Sixth Planner to knit together the work of the Five Planning Initiatives
Consolidated
Program Plan
(VSBA)
Student
Residential
Experience
Arts and
Media
Humanities
Science and
the
Environment
Sports and
Wellness
Wellesley Campus Renewal
16. 16
Conceptual Design Pricing Package

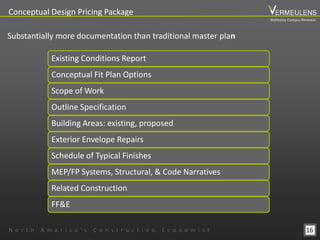

N o r t h A m e r i c a ’ s C o n s t r u c t i o n E c o n o m i s t
Substantially more documentation than traditional master plan
Existing Conditions Report
Conceptual Fit Plan Options
Scope of Work
Outline Specification
Building Areas: existing, proposed
Exterior Envelope Repairs
Schedule of Typical Finishes
MEP/FP Systems, Structural, & Code Narratives
Related Construction
FF&E
Wellesley Campus Renewal
17. 17

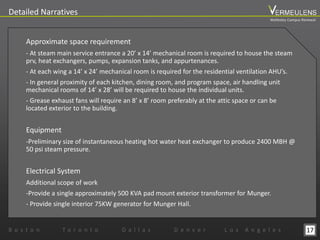

Detailed Narratives
Approximate space requirement
- At steam main service entrance a 20’ x 14’ mechanical room is required to house the steam
prv, heat exchangers, pumps, expansion tanks, and appurtenances.
- At each wing a 14’ x 24’ mechanical room is required for the residential ventilation AHU’s.
- In general proximity of each kitchen, dining room, and program space, air handling unit
mechanical rooms of 14’ x 28’ will be required to house the individual units.
- Grease exhaust fans will require an 8’ x 8’ room preferably at the attic space or can be
located exterior to the building.
Equipment
-Preliminary size of instantaneous heating hot water heat exchanger to produce 2400 MBH @
50 psi steam pressure.
Electrical System
Additional scope of work
-Provide a single approximately 500 KVA pad mount exterior transformer for Munger.
- Provide single interior 75KW generator for Munger Hall.
B o s t o n T o r o n t o D a l l a s D e n v e r L o s A n g e l e s
Wellesley Campus Renewal

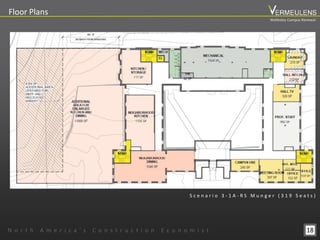

18. 18N o r t h A m e r i c a ’ s C o n s t r u c t i o n E c o n o m i s t
Floor Plans
S c e n a r i o 3 - 1 A - R S M u n g e r ( 3 1 9 S e a t s )
Wellesley Campus Renewal
19. 19
Cost Estimating
Cost Consultant - Vermeulens & Construction Manager - Turner Construction
independently create construction estimates
B o s t o n T o r o n t o D a l l a s D e n v e r L o s A n g e l e s
Wellesley Campus Renewal

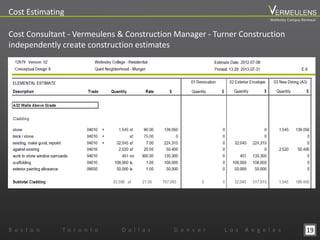

20. 20
Parallel Estimating and Reconciliation
Multi-day reconciliation meeting of CC, CM, Space Planner, and Wellesley
College PM arrive at final construction cost
01 General Conditions $3,522,971 $3,158,939 ($364,032) -10%
02 Site Work $1,263,292 $1,291,482 $28,190 2%
03 Concrete $1,432,892 $1,402,290 ($30,602) -2%
04 Masonry $734,445 $742,510 $8,065 1%
05 Metals $483,451 $481,560 ($1,891) 0%
06 Wood/Plastic $883,679 $897,840 $14,161 2%
07 Thermal and Moisture Protection $991,247 $1,003,138 $11,891 1%
08 Doors/Windows $2,873,880 $2,799,913 ($73,967) -3%
09 Finishes $3,001,949 $3,006,860 $4,911 0%
10 Specialties $312,565 $312,565 $0 0%
11 Equipment $1,617,501 $1,617,501 $0 0%
14 Converying Systems $270,000 $275,000 $5,000 2%
15 Mechanical $4,679,742 $4,743,827 $64,085 1%
16 Electrical $2,069,330 $2,126,564 $57,234 3%
$24,136,944 $23,859,989 ($276,955) -1%
17 Permits and Fees $696,156 $613,144 ($83,012) -12%
18 Contingencies $2,953,389 $2,623,103 ($330,286) -11%
19 Overtime and Out of Hours $0 $0 $0 0%
$3,649,545 $3,236,247 ($413,298) -11%
$27,786,489 $27,096,236 ($690,253) -2%
Direct Construction Costs
Total Markups
Total Construction Costs
N o r t h A m e r i c a ’ s C o n s t r u c t i o n E c o n o m i s t
Wellesley Campus Renewal
21. 21

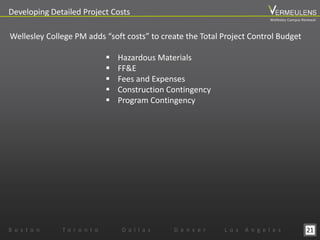

Developing Detailed Project Costs
Wellesley College PM adds “soft costs” to create the Total Project Control Budget
Hazardous Materials
FF&E
Fees and Expenses
Construction Contingency
Program Contingency
B o s t o n T o r o n t o D a l l a s D e n v e r L o s A n g e l e s
Wellesley Campus Renewal
22. 22
Developing Detailed Project Costs
N o r t h A m e r i c a ’ s C o n s t r u c t i o n E c o n o m i s t
Wellesley Campus Renewal
23. 23
Reality Check
Detailed Program and Project Costs
for 24 Buildings
Project Costs Range From $905
million to $1.4 billion (in 2012
dollars)
B o s t o n T o r o n t o D a l l a s D e n v e r L o s A n g e l e s
Wellesley Campus Renewal
24. 24

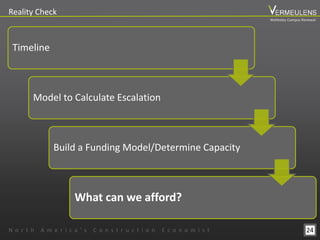

Reality Check
Timeline
Model to Calculate Escalation
Build a Funding Model/Determine Capacity
What can we afford?
N o r t h A m e r i c a ’ s C o n s t r u c t i o n E c o n o m i s t
Wellesley Campus Renewal
25. 25

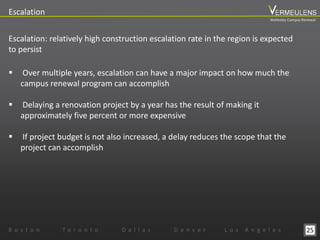

Escalation
Escalation: relatively high construction escalation rate in the region is expected
to persist
Over multiple years, escalation can have a major impact on how much the
campus renewal program can accomplish
Delaying a renovation project by a year has the result of making it
approximately five percent or more expensive
If project budget is not also increased, a delay reduces the scope that the
project can accomplish
B o s t o n T o r o n t o D a l l a s D e n v e r L o s A n g e l e s
Wellesley Campus Renewal
26. 26

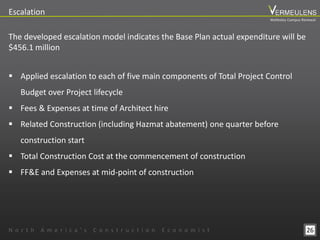

Escalation
The developed escalation model indicates the Base Plan actual expenditure will be
$456.1 million
Applied escalation to each of five main components of Total Project Control
Budget over Project lifecycle
Fees & Expenses at time of Architect hire
Related Construction (including Hazmat abatement) one quarter before
construction start
Total Construction Cost at the commencement of construction
FF&E and Expenses at mid-point of construction
N o r t h A m e r i c a ’ s C o n s t r u c t i o n E c o n o m i s t
Wellesley Campus Renewal
27. 27

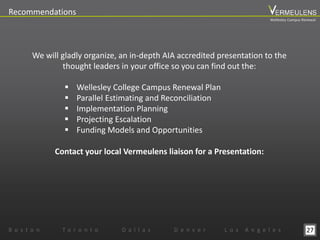

Recommendations
We will gladly organize, an in-depth AIA accredited presentation to the
thought leaders in your office so you can find out the:
Contact your local Vermeulens liaison for a Presentation:
Wellesley College Campus Renewal Plan
Parallel Estimating and Reconciliation
Implementation Planning
Projecting Escalation
Funding Models and Opportunities
B o s t o n T o r o n t o D a l l a s D e n v e r L o s A n g e l e s
Wellesley Campus Renewal
28. 28
Why Vermeulens
Track Record
Project Volume & Benchmarking
Consensus Approach in Reconciliation
Market Outlook
Conceptual Estimating
Trusted Advisor
N o r t h A m e r i c a ’ s C o n s t r u c t i o n E c o n o m i s t
Wellesley Campus Renewal
29. North America’s Construction Economist
Vermeulens.com
B o s t o n T o r o n t o D a l l a s D e n v e r L o s A n g e l e s
Thank You
Since 1972
Wellesley Campus Renewal
Master Planning: A Better Way?
®
Service Beyond Estimation
