Maharashtra Tourism Development Corporation
1
MAHARASHTRA TOURISM DEVELOPMENT CORPORATION
Ajanta Ellora Conservation
& Tourism Development Project
Phase II
Maharashtra Tourism Development Corporation
2

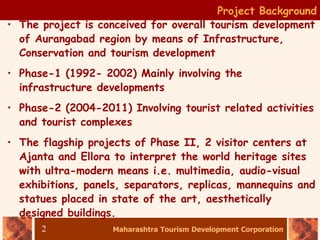

• The project is conceived for overall tourism development
of Aurangabad region by means of Infrastructure,
Conservation and tourism development
• Phase-1 (1992- 2002) Mainly involving the
infrastructure developments
• Phase-2 (2004-2011) Involving tourist related activities
and tourist complexes
• The flagship projects of Phase II, 2 visitor centers at
Ajanta and Ellora to interpret the world heritage sites
with ultra-modern means i.e. multimedia, audio-visual
exhibitions, panels, separators, replicas, mannequins and
statues placed in state of the art, aesthetically
designed buildings.
Project Background
Maharashtra Tourism Development Corporation
3
• Executing Agency : Ministry of Tourism (GoI)
• State-level Monitoring : Government of Maharashtra
• Monitoring Agency : MTDC
• Funding Agency : Japan International Cooperation
Agency (JICA)
• Implementing Agencies : Airport Authority of India (AAI)
Archeological Survey of India (ASI)
Maha.Tourism Development Corp.(MTDC)
Public Works department (PWD)
Forest Department Maha. (FDM)
Maha. Jeevan Pradhikaran (MJP)
State Archeology
Project Organization
• PMC Consultant : Association of Oriental Consultant, Japan &
Tata Consultancy Services (OC-TCS)
Maharashtra Tourism Development Corporation
4
PHASE I
Maharashtra Tourism Development Corporation
5

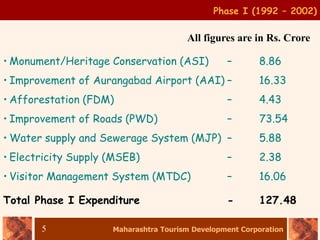

Phase I (1992 – 2002)
Total Phase I Expenditure - 127.48
• Monument/Heritage Conservation (ASI) – 8.86
• Improvement of Aurangabad Airport (AAI) – 16.33
• Afforestation (FDM) – 4.43
• Improvement of Roads (PWD) – 73.54
• Water supply and Sewerage System (MJP) – 5.88
• Electricity Supply (MSEB) – 2.38
• Visitor Management System (MTDC) – 16.06
All figures are in Rs. Crore
Maharashtra Tourism Development Corporation
6
Ajanta Ellora Conservation & Tourism Dvpt- Phase I
Phase I (1992 – 2002)
• Monument/Heritage
Conservation(ASI)-Rs
8.86 Cr.
• Structural and
Chemical Conservation
Works at Ajanta and
Ellora
Conservation
Before &
After
Maharashtra Tourism Development Corporation
7

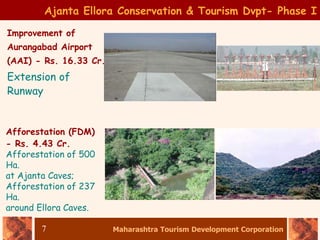

Ajanta Ellora Conservation & Tourism Dvpt- Phase I
Improvement of
Aurangabad Airport
(AAI) - Rs. 16.33 Cr.
Extension of
Runway
Afforestation (FDM)
- Rs. 4.43 Cr.
Afforestation of 500
Ha.
at Ajanta Caves;
Afforestation of 237
Ha.
around Ellora Caves.
Maharashtra Tourism Development Corporation
8
Ajanta Ellora Conservation & Tourism Dvpt- Phase I
Improvement of Roads (PWD) - Rs. 73.54 Cr. (Total 188 km road widened)
• Aurangabad –
Ajanta Caves Road
(113.6 km)
• Aurangabad –
Daulatabad Road
(12.68 km)
• Aurangabad – Ellora
Caves Road (14.0
km)
• Khultabad –
Phulambari Road
(26.4 km)
• Mitmita – Varzadi –
Ellora Road (21.2
km)
• Pathway from
View-point to
Ajanta Caves
Maharashtra Tourism Development Corporation
9
Ajanta Ellora Conservation & Tourism Dvpt- Phase I
Water supply and Sewerage
System (MJP) - Rs. 5.88
Cr.
Raising height of Tondapur
dam
Installation of filtration
plants
Electricity Supply (MSEB)
- Rs. 2.38 Cr.
Augmentation of electricity
supply at Ajanta and
Ellora
Provision of related supply
network
Maharashtra Tourism Development Corporation
10
Ajanta Ellora Conservation & Tourism Dvpt- Phase I
Visitor Management
System (MTDC) - Rs.
16.06 Cr.
• Improvement of
Circulation, Railings etc
• Landscaping and Parking
at Ellora
• Landscaping of Ajanta
Forest Garden
• Ajanta View Point
• Green buses
• Ajanta Shopping
Complex
• Signages- Directional
and Informative
Maharashtra Tourism Development Corporation
11
Ajanta Ellora Conservation & Tourism Dvpt- Phase I
Media and Publicity
• Print Publicity
• Film & Audio-visuals
• PR Activities
• Brochures, Maps &
Folders in National and
International Languages
Maharashtra Tourism Development Corporation
12
PHASE II
Maharashtra Tourism Development Corporation
13
Phase II (2004 – 2011)
SCOPE:
• Monument/Heritage Conservation (ASI)
Ajanta caves Ellora caves Pitalkhora caves
Aurangabad caves Bibi-ka-makbara Daulatabad fort
Patnadevi temple Lonar Crater State Archeological
Monuments
• Infrastructure Development
Aurangabad Airport (AAI) Afforestation (FDM)
Improvement of Roads (PWD) Water supply Schemes (MJP)
• Tourism Development (MTDC)
Ajanta and Ellora Visitor Centres Public Awareness Activities
Human Resource Dvpt. Computerisation of Tourist
Information
Micro-credit Lonar Development
Maharashtra Tourism Development Corporation
14
Component wise Financial Progress
Phase II (2004 – 2011)
Maharashtra Tourism Development Corporation

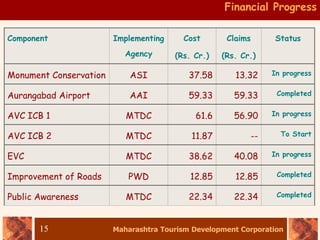

15
Component Implementing
Agency
Cost
(Rs. Cr.)
Claims
(Rs. Cr.)
Status
Monument Conservation ASI 37.58 13.32 In progress
Aurangabad Airport AAI 59.33 59.33 Completed
AVC ICB 1 MTDC 61.6 56.90 In progress
AVC ICB 2 MTDC 11.87 -- To Start
EVC MTDC 38.62 40.08 In progress
Improvement of Roads PWD 12.85 12.85 Completed
Public Awareness MTDC 22.34 22.34 Completed
Financial Progress
Maharashtra Tourism Development Corporation
16
Component Implementing
Agency
Cost
(Rs. Cr.)
Claims
(Rs. Cr.)
Status
Afforestation FDM 1.27 1.27 Completed
Water Supply MJP 3.07 2.97 In progress
Computerisation MTDC 1.78 1.02 In progress
Human Resource Dvpt. MTDC 1.05 0.5 In progress
Lonar Development MTDC 0.9 0.26 In progress
Micro Credit MTDC 0. 50 0. 00
State Archaeology GoM 0.80 0.79 Completed
Total 253.56 210.94
Financial Progress (Cont’d)
Maharashtra Tourism Development Corporation
17

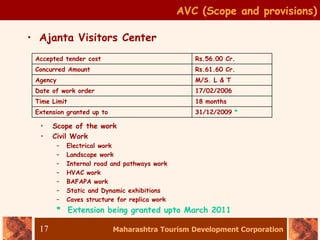

AVC (Scope and provisions)
• Ajanta Visitors Center
Accepted tender cost Rs.56.00 Cr.
Concurred Amount Rs.61.60 Cr.
Agency M/S. L & T
Date of work order 17/02/2006
Time Limit 18 months
Extension granted up to 31/12/2009 *
• Scope of the work
• Civil Work
– Electrical work
– Landscape work
– Internal road and pathways work
– HVAC work
– BAFAPA work
– Static and Dynamic exhibitions
– Caves structure for replica work
* Extension being granted upto March 2011
Maharashtra Tourism Development Corporation
18
Progress
• Ajanta Visitors Center
• Financial Progress
Up to date payments (submitted claims
including retention)
Rs. 56.90 Cr.
Payment for work done Rs. 52.11 Cr.
Payment for escalation Rs. 4.79 Cr.
Maharashtra Tourism Development Corporation
19

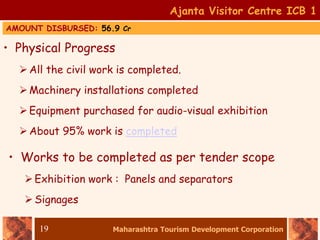

• Physical Progress
All the civil work is completed.
Machinery installations completed
Equipment purchased for audio-visual exhibition
About 95% work is completed
• Works to be completed as per tender scope
Exhibition work : Panels and separators
Signages
Ajanta Visitor Centre ICB 1
AMOUNT DISBURSED: 56.9 Cr
Maharashtra Tourism Development Corporation
20
Ajanta Visitor Centre ICB 1

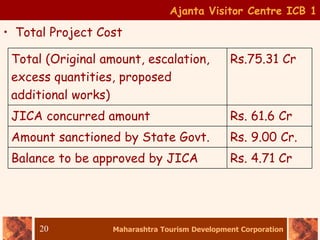

• Total Project Cost
Total (Original amount, escalation,
excess quantities, proposed
additional works)
Rs.75.31 Cr
JICA concurred amount Rs. 61.6 Cr
Amount sanctioned by State Govt. Rs. 9.00 Cr.
Balance to be approved by JICA Rs. 4.71 Cr
Maharashtra Tourism Development Corporation
21

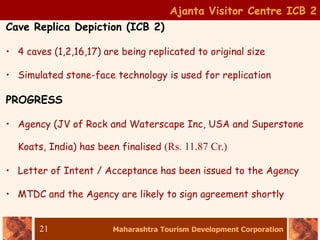

Ajanta Visitor Centre ICB 2
Cave Replica Depiction (ICB 2)
• 4 caves (1,2,16,17) are being replicated to original size
• Simulated stone-face technology is used for replication
PROGRESS
• Agency (JV of Rock and Waterscape Inc, USA and Superstone
Koats, India) has been finalised (Rs. 11.87 Cr.)
• Letter of Intent / Acceptance has been issued to the Agency
• MTDC and the Agency are likely to sign agreement shortly
Maharashtra Tourism Development Corporation
22

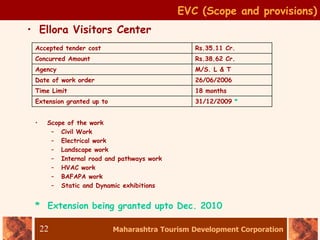

EVC (Scope and provisions)
• Ellora Visitors Center
Accepted tender cost Rs.35.11 Cr.
Concurred Amount Rs.38.62 Cr.
Agency M/S. L & T
Date of work order 26/06/2006
Time Limit 18 months
Extension granted up to 31/12/2009 *
• Scope of the work
– Civil Work
– Electrical work
– Landscape work
– Internal road and pathways work
– HVAC work
– BAFAPA work
– Static and Dynamic exhibitions
* Extension being granted upto Dec. 2010
Maharashtra Tourism Development Corporation
23
Progress

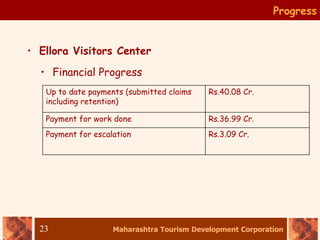

• Ellora Visitors Center
• Financial Progress
Up to date payments (submitted claims
including retention)
Rs.40.08 Cr.
Payment for work done Rs.36.99 Cr.
Payment for escalation Rs.3.09 Cr.
Maharashtra Tourism Development Corporation
24

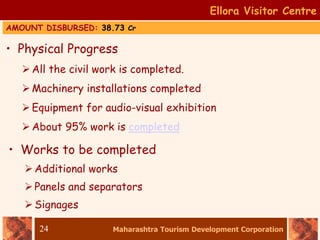

• Physical Progress
All the civil work is completed.
Machinery installations completed
Equipment for audio-visual exhibition
About 95% work is completed
Ellora Visitor Centre
• Works to be completed
Additional works
Panels and separators
Signages
AMOUNT DISBURSED: 38.73 Cr
Maharashtra Tourism Development Corporation
25
Total (Original amount, escalation,
excess quantities, proposed
additional works)
Rs.52.66 Cr
JICA concurred amount Rs. 38.62 Cr
Amount sanctioned by State Gvt. Rs. 9.00 Cr.
Balance to be approved by JICA Rs. 5.04 Cr

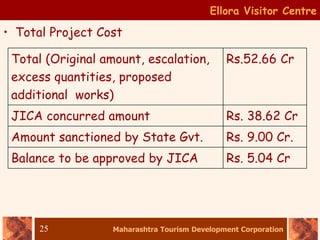

• Total Project Cost
Ellora Visitor Centre
Maharashtra Tourism Development Corporation
26

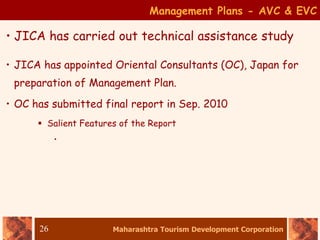

• JICA has carried out technical assistance study
Management Plans - AVC & EVC
• JICA has appointed Oriental Consultants (OC), Japan for
preparation of Management Plan.
• OC has submitted final report in Sep. 2010
 Salient Features of the Report
•
Maharashtra Tourism Development Corporation
27

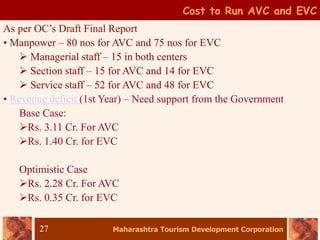

Cost to Run AVC and EVC
As per OC’s Draft Final Report
• Manpower – 80 nos for AVC and 75 nos for EVC
 Managerial staff – 15 in both centers
 Section staff – 15 for AVC and 14 for EVC
 Service staff – 52 for AVC and 48 for EVC
• Revenue deficit (1st Year) – Need support from the Government
Base Case:
Rs. 3.11 Cr. For AVC
Rs. 1.40 Cr. for EVC
Optimistic Case
Rs. 2.28 Cr. For AVC
Rs. 0.35 Cr. for EVC
Maharashtra Tourism Development Corporation
28

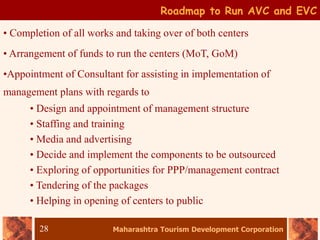

Roadmap to Run AVC and EVC
• Completion of all works and taking over of both centers
• Arrangement of funds to run the centers (MoT, GoM)
•Appointment of Consultant for assisting in implementation of
management plans with regards to
• Design and appointment of management structure
• Staffing and training
• Media and advertising
• Decide and implement the components to be outsourced
• Exploring of opportunities for PPP/management contract
• Tendering of the packages
• Helping in opening of centers to public
Maharashtra Tourism Development Corporation
29

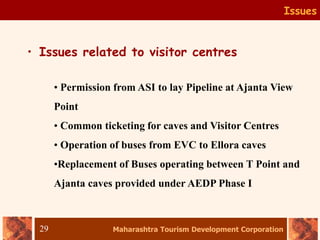

Issues
• Issues related to visitor centres
• Permission from ASI to lay Pipeline at Ajanta View
Point
• Common ticketing for caves and Visitor Centres
• Operation of buses from EVC to Ellora caves
•Replacement of Buses operating between T Point and
Ajanta caves provided under AEDP Phase I
Maharashtra Tourism Development Corporation
30
CFA
Works completed and in progress
by
Tourism Department, Maharashtra
Maharashtra Tourism Development Corporation
31
9th Plan
• All works completed
• All U/C, C/C submitted
Maharashtra Tourism Development Corporation
32
10th Plan (2002-03)
No. Of
Projects
Projects
Completed
Work in
progress
MOT
Sanction
(Rs. Lac)
MOT
Released
(Rs. Lac)
Expenditure
(Rs. Lac)
Percentage
exp. w.r.t.
released
amount
9 6 3 38.00 38.00 38.00 100.00%
List of the works in progress
The works are in progress through CPWD (Funds released directly to CPWD)
1. Development of Jaigad Fort
2. Development of Vijaydurg Fort
3. Development of Sindhudurg Fort (strengthening of Malwan Jetty)
Maharashtra Tourism Development Corporation
33
10th Plan (2003-04)
No. of
Projects
Project s
Completed
Work in
progress
MOT Sanction
(Rs. Lac)
MOT
Released
(Rs. Lac)
Expenditure
(Rs. Lac)
Percentage
exp. w.r.t.
released
amount
10 10 0 952.20 949.95 952.20 100.00%
All the works in the scheme are completed.
Maharashtra Tourism Development Corporation
34
List of works
1. Infrastructure and destination development of Mahabaleshwar
Dist. Satara. Phase-I.
• Work completed.
2. Infrastructure and destination development of Malshej Ghat,
Dist. Pune
• Work completed. (U/C, C/C submitted)
• Request for release of final installment of Rs. 1 Crore 41 Lacs.
10th Plan (2004-05)
No. Of
Projects
Project s
Completed
Work in
progress
MOT
Sanction
(Rs. Lac)
MOT
Released
(Rs. Lac)
Expenditure
(Rs. Lac)
Percentage
exp. w.r.t.
released
amount
10 10 0 1674.91 1217.19 1373.54 100.00%
Maharashtra Tourism Development Corporation
35
10th Plan (2005-06)
List of the works in progress
1. CFA for the Konkan Riviera Part-III
• Work completed.
• Some components could not be taken up due to ASI objections and land problems.
(Details submitted with U/C)
• Request for completion of the project at released amount of Rs. 4 Crores 75 Lacs
2. Development of Matheran
• Work in progress.
• TRC bldg construction could not be taken up due to land problem.
(Details submitted with U/C)
• Extension is requested up to 31/03/2011.
• Request for completion of the project at released amount of Rs. 3 Crores 61 Lacs
No. Of
Projects
Project s
Completed
Work in
progress
MOT
Sanction
(Rs. Lac)
MOT
Released
(Rs. Lac)
Expenditure
(Rs. Lac)
Percentage
exp. w.r.t.
released
amount
8 4 4 2030.72 1629.54 1270.67 77.98%
Maharashtra Tourism Development Corporation
36

3. Destination development Karla, Pune
• Work in progress.
• Karla caves parking & toilet construction could not be taken up due to Forest
objection (Details submitted with U/C)
• Extension is requested up to 31/12/2010.
• Request for completion of the project at released amount of Rs. 3 Crores 88 Lacs
4. Rejuvenation of Singhgad Fort, Dist-Pune.
• Work in progress.
• Look out Points and some pathways could not be taken up due to ASI objection.
(Details submitted with U/C)
• Extension is requested up to 31/06/2011.
• Request for completion of the project at released amount of Rs. 3 Crores 76 Lacs
10th Plan (2005-06)
Maharashtra Tourism Development Corporation
37

10th Plan (2006-07)
No. Of
Projects
Project s
Completed
Work in
progress
MOT
Sanction
(Rs. Lac)
MOT
Released
(Rs. Lac)
Expenditure
(Rs. Lac)
Percentage
exp. w.r.t.
released
amount
14 6 8 2869.32 2296.46 1883.27 82.01%
List of the works in progress
1. Infrastructure and destination development of Mahabaleshwar-II
Dist. Satara.
• Work in progress.
• Aurther Seat Point development could not be taken up due to Forest objection
(Details submitted with U/C)
• Extension is requested up to 31/12/2010.
• Request for completion of the project at released amount of Rs. 3 Crores 84 Lacs
2. Development Kolhapur Circuit
• Work in progress.
• Panhala work is stopped by ASI
• Extension is requested up to 31/12/2010.
Maharashtra Tourism Development Corporation
38
10th Plan (2006-07)
3. Mumbai Fort Circuit.
• Work in progress.
• Siwari Fort Bay development could not be taken up due to BPT objections.
(Details submitted with U/C)
• Extension is requested up to 31/12/2010.
4. Pre-feasibility report for the new Mahableshwar
5. Destination dev of Kunkeshwar
• Work in progress.
• Work delayed due to opposition by local villagers( started in Nov 2009).
• Extension is requested up to 31/03/2011.
6. Art and Craft Centre at Aurangabad.
• Work completed.
• Request to release final installment of Rs. 88 Lacs 44 Thousand
Maharashtra Tourism Development Corporation
39
10th Plan (2006-07)
7. Dev. of Rural Tourism in Morachi Chincholi (Hardware Component)
• Work completed.
• Request to release final installment of Rs. 10 Lacs
8. Capacity buillding, service provider Morachi Chincholi.
(software Component)
• Work in progress.
• Extension is requested up to 31/12/2010.
Maharashtra Tourism Development Corporation
40
11th Plan (2007-08)
No. Of
Projects
Project s
Completed
Work in
progress
MOT
Sanction
(Rs. Lac)
MOT
Released
(Rs. Lac)
Expenditure
(Rs. Lac)
Percentage
exp. w.r.t.
released
amount
4 0 4 2259.24 1207.38 223.16 18.48%
List of the works in progress
1. Development of Art and Craft Village at Mumbai in Maharashtra
• Tenders were cancelled due to land problems.
• Taking over possession of the Land is in progress.
• Extension requested up to 31/12/2011.
2. Destination Development at Mandhradevi, tal. Wai, Dist. Satara in Maharashtr
• Work delayed due to local problems
• Work in progress.
• Extension requested up to 31/03/2011
Maharashtra Tourism Development Corporation
41

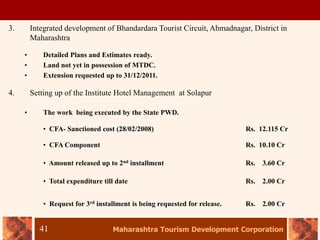

3. Integrated development of Bhandardara Tourist Circuit, Ahmadnagar, District in
Maharashtra
• Detailed Plans and Estimates ready.
• Land not yet in possession of MTDC.
• Extension requested up to 31/12/2011.
4. Setting up of the Institute Hotel Management at Solapur
• The work being executed by the State PWD.
• CFA- Sanctioned cost (28/02/2008) Rs. 12.115 Cr
• CFA Component Rs. 10.10 Cr
• Amount released up to 2nd installment Rs. 3.60 Cr
• Total expenditure till date Rs. 2.00 Cr
• Request for 3rd installment is being requested for release. Rs. 2.00 Cr
Maharashtra Tourism Development Corporation
42

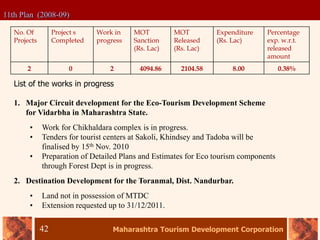

11th Plan (2008-09)
No. Of
Projects
Project s
Completed
Work in
progress
MOT
Sanction
(Rs. Lac)
MOT
Released
(Rs. Lac)
Expenditure
(Rs. Lac)
Percentage
exp. w.r.t.
released
amount
2 0 2 4094.86 2104.58 8.00 0.38%
List of the works in progress
1. Major Circuit development for the Eco-Tourism Development Scheme
for Vidarbha in Maharashtra State.
• Work for Chikhaldara complex is in progress.
• Tenders for tourist centers at Sakoli, Khindsey and Tadoba will be
finalised by 15th Nov. 2010
• Preparation of Detailed Plans and Estimates for Eco tourism components
through Forest Dept is in progress.
2. Destination Development for the Toranmal, Dist. Nandurbar.
• Land not in possession of MTDC
• Extension requested up to 31/12/2011.
Maharashtra Tourism Development Corporation
43
11th Plan (2009-10)
No. Of
Projects
Project s
Completed
Work in
progress
MOT
Sanction
(Rs. Lac)
MOT
Released
(Rs. Lac)
Expenditure
(Rs. Lac)
Percentage
exp. w.r.t.
released
amount
1 0 1 486.00 388. 80 388.80 -
List of the works in progress
1. Architectural and Theme lighting at Chatrapati Shivaji Terminus Building,
Mumbai.
• Work being executed by Central Railways.
• The released amount transferred to Central Railways.
Maharashtra Tourism Development Corporation
44

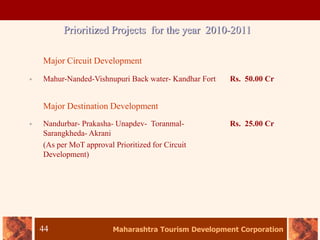

Prioritized Projects for the year 2010-2011
Major Circuit Development
• Mahur-Nanded-Vishnupuri Back water- Kandhar Fort Rs. 50.00 Cr
Major Destination Development
• Nandurbar- Prakasha- Unapdev- Toranmal-
Sarangkheda- Akrani
(As per MoT approval Prioritized for Circuit
Development)
Rs. 25.00 Cr
Maharashtra Tourism Development Corporation
45

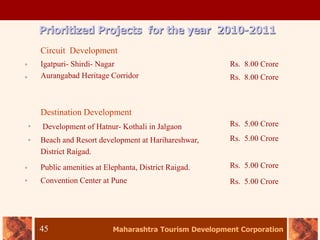

Prioritized Projects for the year 2010-2011
Circuit Development
•
•
Igatpuri- Shirdi- Nagar
Aurangabad Heritage Corridor
Rs. 8.00 Crore
Rs. 8.00 Crore
Destination Development
•
•
Development of Hatnur- Kothali in Jalgaon
Beach and Resort development at Harihareshwar,
District Raigad.
Rs. 5.00 Crore
Rs. 5.00 Crore
•
•
Public amenities at Elephanta, District Raigad.
Convention Center at Pune
Rs. 5.00 Crore
Rs. 5.00 Crore
Maharashtra Tourism Development Corporation
46
Prioritized Projects for the year 2010-2011
Rural Tourism
•
•
Village Babhalleshwar, near Shirdi in Ahamadnagar
District
Village Sajiwali in Thane District.
Rs. 50.00 Lacs
Rs. 50.00 Lacs
•
Computerization
Project report is under preparation
Maharashtra Tourism Development Corporation
47
Photographs of the completed schemes
Tourist Complex at Khindsey
Ramtek
Maharashtra Tourism Development Corporation
48
Tourist Complex at Khekra Nala
Nagpur
Maharashtra Tourism Development Corporation
49
Tourist Complex at Sillari Nagpur
Maharashtra Tourism Development Corporation
50
Development at Mahableshwar
Maharashtra Tourism Development Corporation
51
Tent Resort at Diveagar under KR-
II
Maharashtra Tourism Development Corporation
52
Development of Lonar Buldhana
Maharashtra Tourism Development Corporation
53
Bamboo Boat House Tarkarli
Maharashtra Tourism Development Corporation
54
House Boat at Tarkarli
Maharashtra Tourism Development Corporation
55
THANK YOU

Vision Document Ajanta Ellora Aurangabad Development Project

  • 1.
    Maharashtra Tourism DevelopmentCorporation 1 MAHARASHTRA TOURISM DEVELOPMENT CORPORATION Ajanta Ellora Conservation & Tourism Development Project Phase II
  • 2.
    Maharashtra Tourism DevelopmentCorporation 2 • The project is conceived for overall tourism development of Aurangabad region by means of Infrastructure, Conservation and tourism development • Phase-1 (1992- 2002) Mainly involving the infrastructure developments • Phase-2 (2004-2011) Involving tourist related activities and tourist complexes • The flagship projects of Phase II, 2 visitor centers at Ajanta and Ellora to interpret the world heritage sites with ultra-modern means i.e. multimedia, audio-visual exhibitions, panels, separators, replicas, mannequins and statues placed in state of the art, aesthetically designed buildings. Project Background
  • 3.
    Maharashtra Tourism DevelopmentCorporation 3 • Executing Agency : Ministry of Tourism (GoI) • State-level Monitoring : Government of Maharashtra • Monitoring Agency : MTDC • Funding Agency : Japan International Cooperation Agency (JICA) • Implementing Agencies : Airport Authority of India (AAI) Archeological Survey of India (ASI) Maha.Tourism Development Corp.(MTDC) Public Works department (PWD) Forest Department Maha. (FDM) Maha. Jeevan Pradhikaran (MJP) State Archeology Project Organization • PMC Consultant : Association of Oriental Consultant, Japan & Tata Consultancy Services (OC-TCS)
  • 4.
    Maharashtra Tourism DevelopmentCorporation 4 PHASE I
  • 5.
    Maharashtra Tourism DevelopmentCorporation 5 Phase I (1992 – 2002) Total Phase I Expenditure - 127.48 • Monument/Heritage Conservation (ASI) – 8.86 • Improvement of Aurangabad Airport (AAI) – 16.33 • Afforestation (FDM) – 4.43 • Improvement of Roads (PWD) – 73.54 • Water supply and Sewerage System (MJP) – 5.88 • Electricity Supply (MSEB) – 2.38 • Visitor Management System (MTDC) – 16.06 All figures are in Rs. Crore
  • 6.
    Maharashtra Tourism DevelopmentCorporation 6 Ajanta Ellora Conservation & Tourism Dvpt- Phase I Phase I (1992 – 2002) • Monument/Heritage Conservation(ASI)-Rs 8.86 Cr. • Structural and Chemical Conservation Works at Ajanta and Ellora Conservation Before & After
  • 7.
    Maharashtra Tourism DevelopmentCorporation 7 Ajanta Ellora Conservation & Tourism Dvpt- Phase I Improvement of Aurangabad Airport (AAI) - Rs. 16.33 Cr. Extension of Runway Afforestation (FDM) - Rs. 4.43 Cr. Afforestation of 500 Ha. at Ajanta Caves; Afforestation of 237 Ha. around Ellora Caves.
  • 8.
    Maharashtra Tourism DevelopmentCorporation 8 Ajanta Ellora Conservation & Tourism Dvpt- Phase I Improvement of Roads (PWD) - Rs. 73.54 Cr. (Total 188 km road widened) • Aurangabad – Ajanta Caves Road (113.6 km) • Aurangabad – Daulatabad Road (12.68 km) • Aurangabad – Ellora Caves Road (14.0 km) • Khultabad – Phulambari Road (26.4 km) • Mitmita – Varzadi – Ellora Road (21.2 km) • Pathway from View-point to Ajanta Caves
  • 9.
    Maharashtra Tourism DevelopmentCorporation 9 Ajanta Ellora Conservation & Tourism Dvpt- Phase I Water supply and Sewerage System (MJP) - Rs. 5.88 Cr. Raising height of Tondapur dam Installation of filtration plants Electricity Supply (MSEB) - Rs. 2.38 Cr. Augmentation of electricity supply at Ajanta and Ellora Provision of related supply network
  • 10.
    Maharashtra Tourism DevelopmentCorporation 10 Ajanta Ellora Conservation & Tourism Dvpt- Phase I Visitor Management System (MTDC) - Rs. 16.06 Cr. • Improvement of Circulation, Railings etc • Landscaping and Parking at Ellora • Landscaping of Ajanta Forest Garden • Ajanta View Point • Green buses • Ajanta Shopping Complex • Signages- Directional and Informative
  • 11.
    Maharashtra Tourism DevelopmentCorporation 11 Ajanta Ellora Conservation & Tourism Dvpt- Phase I Media and Publicity • Print Publicity • Film & Audio-visuals • PR Activities • Brochures, Maps & Folders in National and International Languages
  • 12.
    Maharashtra Tourism DevelopmentCorporation 12 PHASE II
  • 13.
    Maharashtra Tourism DevelopmentCorporation 13 Phase II (2004 – 2011) SCOPE: • Monument/Heritage Conservation (ASI) Ajanta caves Ellora caves Pitalkhora caves Aurangabad caves Bibi-ka-makbara Daulatabad fort Patnadevi temple Lonar Crater State Archeological Monuments • Infrastructure Development Aurangabad Airport (AAI) Afforestation (FDM) Improvement of Roads (PWD) Water supply Schemes (MJP) • Tourism Development (MTDC) Ajanta and Ellora Visitor Centres Public Awareness Activities Human Resource Dvpt. Computerisation of Tourist Information Micro-credit Lonar Development
  • 14.
    Maharashtra Tourism DevelopmentCorporation 14 Component wise Financial Progress Phase II (2004 – 2011)
  • 15.
    Maharashtra Tourism DevelopmentCorporation 15 Component Implementing Agency Cost (Rs. Cr.) Claims (Rs. Cr.) Status Monument Conservation ASI 37.58 13.32 In progress Aurangabad Airport AAI 59.33 59.33 Completed AVC ICB 1 MTDC 61.6 56.90 In progress AVC ICB 2 MTDC 11.87 -- To Start EVC MTDC 38.62 40.08 In progress Improvement of Roads PWD 12.85 12.85 Completed Public Awareness MTDC 22.34 22.34 Completed Financial Progress
  • 16.
    Maharashtra Tourism DevelopmentCorporation 16 Component Implementing Agency Cost (Rs. Cr.) Claims (Rs. Cr.) Status Afforestation FDM 1.27 1.27 Completed Water Supply MJP 3.07 2.97 In progress Computerisation MTDC 1.78 1.02 In progress Human Resource Dvpt. MTDC 1.05 0.5 In progress Lonar Development MTDC 0.9 0.26 In progress Micro Credit MTDC 0. 50 0. 00 State Archaeology GoM 0.80 0.79 Completed Total 253.56 210.94 Financial Progress (Cont’d)
  • 17.
    Maharashtra Tourism DevelopmentCorporation 17 AVC (Scope and provisions) • Ajanta Visitors Center Accepted tender cost Rs.56.00 Cr. Concurred Amount Rs.61.60 Cr. Agency M/S. L & T Date of work order 17/02/2006 Time Limit 18 months Extension granted up to 31/12/2009 * • Scope of the work • Civil Work – Electrical work – Landscape work – Internal road and pathways work – HVAC work – BAFAPA work – Static and Dynamic exhibitions – Caves structure for replica work * Extension being granted upto March 2011
  • 18.
    Maharashtra Tourism DevelopmentCorporation 18 Progress • Ajanta Visitors Center • Financial Progress Up to date payments (submitted claims including retention) Rs. 56.90 Cr. Payment for work done Rs. 52.11 Cr. Payment for escalation Rs. 4.79 Cr.
  • 19.
    Maharashtra Tourism DevelopmentCorporation 19 • Physical Progress All the civil work is completed. Machinery installations completed Equipment purchased for audio-visual exhibition About 95% work is completed • Works to be completed as per tender scope Exhibition work : Panels and separators Signages Ajanta Visitor Centre ICB 1 AMOUNT DISBURSED: 56.9 Cr
  • 20.
    Maharashtra Tourism DevelopmentCorporation 20 Ajanta Visitor Centre ICB 1 • Total Project Cost Total (Original amount, escalation, excess quantities, proposed additional works) Rs.75.31 Cr JICA concurred amount Rs. 61.6 Cr Amount sanctioned by State Govt. Rs. 9.00 Cr. Balance to be approved by JICA Rs. 4.71 Cr
  • 21.
    Maharashtra Tourism DevelopmentCorporation 21 Ajanta Visitor Centre ICB 2 Cave Replica Depiction (ICB 2) • 4 caves (1,2,16,17) are being replicated to original size • Simulated stone-face technology is used for replication PROGRESS • Agency (JV of Rock and Waterscape Inc, USA and Superstone Koats, India) has been finalised (Rs. 11.87 Cr.) • Letter of Intent / Acceptance has been issued to the Agency • MTDC and the Agency are likely to sign agreement shortly
  • 22.
    Maharashtra Tourism DevelopmentCorporation 22 EVC (Scope and provisions) • Ellora Visitors Center Accepted tender cost Rs.35.11 Cr. Concurred Amount Rs.38.62 Cr. Agency M/S. L & T Date of work order 26/06/2006 Time Limit 18 months Extension granted up to 31/12/2009 * • Scope of the work – Civil Work – Electrical work – Landscape work – Internal road and pathways work – HVAC work – BAFAPA work – Static and Dynamic exhibitions * Extension being granted upto Dec. 2010
  • 23.
    Maharashtra Tourism DevelopmentCorporation 23 Progress • Ellora Visitors Center • Financial Progress Up to date payments (submitted claims including retention) Rs.40.08 Cr. Payment for work done Rs.36.99 Cr. Payment for escalation Rs.3.09 Cr.
  • 24.
    Maharashtra Tourism DevelopmentCorporation 24 • Physical Progress All the civil work is completed. Machinery installations completed Equipment for audio-visual exhibition About 95% work is completed Ellora Visitor Centre • Works to be completed Additional works Panels and separators Signages AMOUNT DISBURSED: 38.73 Cr
  • 25.
    Maharashtra Tourism DevelopmentCorporation 25 Total (Original amount, escalation, excess quantities, proposed additional works) Rs.52.66 Cr JICA concurred amount Rs. 38.62 Cr Amount sanctioned by State Gvt. Rs. 9.00 Cr. Balance to be approved by JICA Rs. 5.04 Cr • Total Project Cost Ellora Visitor Centre
  • 26.
    Maharashtra Tourism DevelopmentCorporation 26 • JICA has carried out technical assistance study Management Plans - AVC & EVC • JICA has appointed Oriental Consultants (OC), Japan for preparation of Management Plan. • OC has submitted final report in Sep. 2010  Salient Features of the Report •
  • 27.
    Maharashtra Tourism DevelopmentCorporation 27 Cost to Run AVC and EVC As per OC’s Draft Final Report • Manpower – 80 nos for AVC and 75 nos for EVC  Managerial staff – 15 in both centers  Section staff – 15 for AVC and 14 for EVC  Service staff – 52 for AVC and 48 for EVC • Revenue deficit (1st Year) – Need support from the Government Base Case: Rs. 3.11 Cr. For AVC Rs. 1.40 Cr. for EVC Optimistic Case Rs. 2.28 Cr. For AVC Rs. 0.35 Cr. for EVC
  • 28.
    Maharashtra Tourism DevelopmentCorporation 28 Roadmap to Run AVC and EVC • Completion of all works and taking over of both centers • Arrangement of funds to run the centers (MoT, GoM) •Appointment of Consultant for assisting in implementation of management plans with regards to • Design and appointment of management structure • Staffing and training • Media and advertising • Decide and implement the components to be outsourced • Exploring of opportunities for PPP/management contract • Tendering of the packages • Helping in opening of centers to public
  • 29.
    Maharashtra Tourism DevelopmentCorporation 29 Issues • Issues related to visitor centres • Permission from ASI to lay Pipeline at Ajanta View Point • Common ticketing for caves and Visitor Centres • Operation of buses from EVC to Ellora caves •Replacement of Buses operating between T Point and Ajanta caves provided under AEDP Phase I
  • 30.
    Maharashtra Tourism DevelopmentCorporation 30 CFA Works completed and in progress by Tourism Department, Maharashtra
  • 31.
    Maharashtra Tourism DevelopmentCorporation 31 9th Plan • All works completed • All U/C, C/C submitted
  • 32.
    Maharashtra Tourism DevelopmentCorporation 32 10th Plan (2002-03) No. Of Projects Projects Completed Work in progress MOT Sanction (Rs. Lac) MOT Released (Rs. Lac) Expenditure (Rs. Lac) Percentage exp. w.r.t. released amount 9 6 3 38.00 38.00 38.00 100.00% List of the works in progress The works are in progress through CPWD (Funds released directly to CPWD) 1. Development of Jaigad Fort 2. Development of Vijaydurg Fort 3. Development of Sindhudurg Fort (strengthening of Malwan Jetty)
  • 33.
    Maharashtra Tourism DevelopmentCorporation 33 10th Plan (2003-04) No. of Projects Project s Completed Work in progress MOT Sanction (Rs. Lac) MOT Released (Rs. Lac) Expenditure (Rs. Lac) Percentage exp. w.r.t. released amount 10 10 0 952.20 949.95 952.20 100.00% All the works in the scheme are completed.
  • 34.
    Maharashtra Tourism DevelopmentCorporation 34 List of works 1. Infrastructure and destination development of Mahabaleshwar Dist. Satara. Phase-I. • Work completed. 2. Infrastructure and destination development of Malshej Ghat, Dist. Pune • Work completed. (U/C, C/C submitted) • Request for release of final installment of Rs. 1 Crore 41 Lacs. 10th Plan (2004-05) No. Of Projects Project s Completed Work in progress MOT Sanction (Rs. Lac) MOT Released (Rs. Lac) Expenditure (Rs. Lac) Percentage exp. w.r.t. released amount 10 10 0 1674.91 1217.19 1373.54 100.00%
  • 35.
    Maharashtra Tourism DevelopmentCorporation 35 10th Plan (2005-06) List of the works in progress 1. CFA for the Konkan Riviera Part-III • Work completed. • Some components could not be taken up due to ASI objections and land problems. (Details submitted with U/C) • Request for completion of the project at released amount of Rs. 4 Crores 75 Lacs 2. Development of Matheran • Work in progress. • TRC bldg construction could not be taken up due to land problem. (Details submitted with U/C) • Extension is requested up to 31/03/2011. • Request for completion of the project at released amount of Rs. 3 Crores 61 Lacs No. Of Projects Project s Completed Work in progress MOT Sanction (Rs. Lac) MOT Released (Rs. Lac) Expenditure (Rs. Lac) Percentage exp. w.r.t. released amount 8 4 4 2030.72 1629.54 1270.67 77.98%
  • 36.
    Maharashtra Tourism DevelopmentCorporation 36 3. Destination development Karla, Pune • Work in progress. • Karla caves parking & toilet construction could not be taken up due to Forest objection (Details submitted with U/C) • Extension is requested up to 31/12/2010. • Request for completion of the project at released amount of Rs. 3 Crores 88 Lacs 4. Rejuvenation of Singhgad Fort, Dist-Pune. • Work in progress. • Look out Points and some pathways could not be taken up due to ASI objection. (Details submitted with U/C) • Extension is requested up to 31/06/2011. • Request for completion of the project at released amount of Rs. 3 Crores 76 Lacs 10th Plan (2005-06)
  • 37.
    Maharashtra Tourism DevelopmentCorporation 37 10th Plan (2006-07) No. Of Projects Project s Completed Work in progress MOT Sanction (Rs. Lac) MOT Released (Rs. Lac) Expenditure (Rs. Lac) Percentage exp. w.r.t. released amount 14 6 8 2869.32 2296.46 1883.27 82.01% List of the works in progress 1. Infrastructure and destination development of Mahabaleshwar-II Dist. Satara. • Work in progress. • Aurther Seat Point development could not be taken up due to Forest objection (Details submitted with U/C) • Extension is requested up to 31/12/2010. • Request for completion of the project at released amount of Rs. 3 Crores 84 Lacs 2. Development Kolhapur Circuit • Work in progress. • Panhala work is stopped by ASI • Extension is requested up to 31/12/2010.
  • 38.
    Maharashtra Tourism DevelopmentCorporation 38 10th Plan (2006-07) 3. Mumbai Fort Circuit. • Work in progress. • Siwari Fort Bay development could not be taken up due to BPT objections. (Details submitted with U/C) • Extension is requested up to 31/12/2010. 4. Pre-feasibility report for the new Mahableshwar 5. Destination dev of Kunkeshwar • Work in progress. • Work delayed due to opposition by local villagers( started in Nov 2009). • Extension is requested up to 31/03/2011. 6. Art and Craft Centre at Aurangabad. • Work completed. • Request to release final installment of Rs. 88 Lacs 44 Thousand
  • 39.
    Maharashtra Tourism DevelopmentCorporation 39 10th Plan (2006-07) 7. Dev. of Rural Tourism in Morachi Chincholi (Hardware Component) • Work completed. • Request to release final installment of Rs. 10 Lacs 8. Capacity buillding, service provider Morachi Chincholi. (software Component) • Work in progress. • Extension is requested up to 31/12/2010.
  • 40.
    Maharashtra Tourism DevelopmentCorporation 40 11th Plan (2007-08) No. Of Projects Project s Completed Work in progress MOT Sanction (Rs. Lac) MOT Released (Rs. Lac) Expenditure (Rs. Lac) Percentage exp. w.r.t. released amount 4 0 4 2259.24 1207.38 223.16 18.48% List of the works in progress 1. Development of Art and Craft Village at Mumbai in Maharashtra • Tenders were cancelled due to land problems. • Taking over possession of the Land is in progress. • Extension requested up to 31/12/2011. 2. Destination Development at Mandhradevi, tal. Wai, Dist. Satara in Maharashtr • Work delayed due to local problems • Work in progress. • Extension requested up to 31/03/2011
  • 41.
    Maharashtra Tourism DevelopmentCorporation 41 3. Integrated development of Bhandardara Tourist Circuit, Ahmadnagar, District in Maharashtra • Detailed Plans and Estimates ready. • Land not yet in possession of MTDC. • Extension requested up to 31/12/2011. 4. Setting up of the Institute Hotel Management at Solapur • The work being executed by the State PWD. • CFA- Sanctioned cost (28/02/2008) Rs. 12.115 Cr • CFA Component Rs. 10.10 Cr • Amount released up to 2nd installment Rs. 3.60 Cr • Total expenditure till date Rs. 2.00 Cr • Request for 3rd installment is being requested for release. Rs. 2.00 Cr
  • 42.
    Maharashtra Tourism DevelopmentCorporation 42 11th Plan (2008-09) No. Of Projects Project s Completed Work in progress MOT Sanction (Rs. Lac) MOT Released (Rs. Lac) Expenditure (Rs. Lac) Percentage exp. w.r.t. released amount 2 0 2 4094.86 2104.58 8.00 0.38% List of the works in progress 1. Major Circuit development for the Eco-Tourism Development Scheme for Vidarbha in Maharashtra State. • Work for Chikhaldara complex is in progress. • Tenders for tourist centers at Sakoli, Khindsey and Tadoba will be finalised by 15th Nov. 2010 • Preparation of Detailed Plans and Estimates for Eco tourism components through Forest Dept is in progress. 2. Destination Development for the Toranmal, Dist. Nandurbar. • Land not in possession of MTDC • Extension requested up to 31/12/2011.
  • 43.
    Maharashtra Tourism DevelopmentCorporation 43 11th Plan (2009-10) No. Of Projects Project s Completed Work in progress MOT Sanction (Rs. Lac) MOT Released (Rs. Lac) Expenditure (Rs. Lac) Percentage exp. w.r.t. released amount 1 0 1 486.00 388. 80 388.80 - List of the works in progress 1. Architectural and Theme lighting at Chatrapati Shivaji Terminus Building, Mumbai. • Work being executed by Central Railways. • The released amount transferred to Central Railways.
  • 44.
    Maharashtra Tourism DevelopmentCorporation 44 Prioritized Projects for the year 2010-2011 Major Circuit Development • Mahur-Nanded-Vishnupuri Back water- Kandhar Fort Rs. 50.00 Cr Major Destination Development • Nandurbar- Prakasha- Unapdev- Toranmal- Sarangkheda- Akrani (As per MoT approval Prioritized for Circuit Development) Rs. 25.00 Cr
  • 45.
    Maharashtra Tourism DevelopmentCorporation 45 Prioritized Projects for the year 2010-2011 Circuit Development • • Igatpuri- Shirdi- Nagar Aurangabad Heritage Corridor Rs. 8.00 Crore Rs. 8.00 Crore Destination Development • • Development of Hatnur- Kothali in Jalgaon Beach and Resort development at Harihareshwar, District Raigad. Rs. 5.00 Crore Rs. 5.00 Crore • • Public amenities at Elephanta, District Raigad. Convention Center at Pune Rs. 5.00 Crore Rs. 5.00 Crore
  • 46.
    Maharashtra Tourism DevelopmentCorporation 46 Prioritized Projects for the year 2010-2011 Rural Tourism • • Village Babhalleshwar, near Shirdi in Ahamadnagar District Village Sajiwali in Thane District. Rs. 50.00 Lacs Rs. 50.00 Lacs • Computerization Project report is under preparation
  • 47.
    Maharashtra Tourism DevelopmentCorporation 47 Photographs of the completed schemes Tourist Complex at Khindsey Ramtek
  • 48.
    Maharashtra Tourism DevelopmentCorporation 48 Tourist Complex at Khekra Nala Nagpur
  • 49.
    Maharashtra Tourism DevelopmentCorporation 49 Tourist Complex at Sillari Nagpur
  • 50.
    Maharashtra Tourism DevelopmentCorporation 50 Development at Mahableshwar
  • 51.
    Maharashtra Tourism DevelopmentCorporation 51 Tent Resort at Diveagar under KR- II
  • 52.
    Maharashtra Tourism DevelopmentCorporation 52 Development of Lonar Buldhana
  • 53.
    Maharashtra Tourism DevelopmentCorporation 53 Bamboo Boat House Tarkarli
  • 54.
    Maharashtra Tourism DevelopmentCorporation 54 House Boat at Tarkarli
  • 55.
    Maharashtra Tourism DevelopmentCorporation 55 THANK YOU
