Application for the Post of QA QC Professionals
Page 1 of 7
Vinu Ramasamy
Contact No.: +919443543842,UAE:+971503204811,
E-mail: harinigayathri2002@yahoo.co.in
Vinu.ramasamy@gmail.com
skype ID: harinigayathri
https://in.linkedin.com/pub/ramasamy-vinu/3b/793/7b7
Dated: August 2016
To,
The HR Manager,
It was with great interest that I would like to apply for a Position of Quality Manager, Inspection
Engineer,Lead QA/QC Engineer or Team Leader or suitable onein your esteemed organization. Review of
my credentials will confirm that I am capable of serving as a catalyst for achieving objectives and organic
growth through effective contributions. Recently Worked as a Deputy Quality Manager, with Petrofac
Oman for BP Khazzan Project with 30 QA/QC Engineers & Inspectors.Earlier I have worked as a
QA/QCTeam Leader for GASCO, which covers of Overall responsibility for Quality management across
multiple sites of HSGP Project, Overseeing all Quality assurance and Quality control activities for Multiple
sites of project covering Procurement , Construction , Inspection/ Testing and Commissioning phases,
Effective design & implementation of the Quality Management System in accordance with applicable
standard. Responsible for technical assistance and control of Standard Quality and Operating procedures
across EPC Management of Non conformity process, Implement corrective and Preventive action & monitor
its effectiveness Shared cross-functionally. Provide assistance to Project management team for the
implementation of the Project QMS by contractors, subcontractors and vendors covering management,
engineering, procurement, construction and commissioning activities. Conduct Quality Audit/ Assessments
(Internal and external) and manage multi-discipline QA/ QC teams, Experience in Quality Management in all
the EPC phases of oil and gas projects, Technically sound in QA/ QC & also have experience for working with
international clients.Administratively & functionally Resolving technical issues , Active Participating of PMTC,
QA QC ,Weekly progress meetings, Conducting &participating company technical compliance audits for
contractor, Stage wise QAQC requirements as per contract documents, Contractor’s QC -CV approval as per
the company contractual requirements,Reviewing of vendor& contractor documents of ITP’S, Method
statements, FAT, Quality Manuals, Welding Book(PQR,WPS), vendor inspection activities, Attending Pre-
Inspection Meetings(PIM), Vendor Inspection Co-ordinations with TPI, Approving of TPI -CV ‘s, Reviewing
of TPI Reports, Vendor’s Auditing ,Inspection of SEET Sulphur Pipelines, Fuel GAS, Nitrogen & GRE
Pipelines, Material Receiving Inspection, Mechanical Equipment Erection, Final Walk down of Tanks ,
Reviewing of DCA & FCN, Material document review in conjunction with code and specification, Ensuring
compliance of all EPC activities with applicable GASCO Design General Specifications (DGS) and codes&
issuing NCR if any noncompliance with project requirements.
I possess over24years of experience in oil, gas and LNG sectors in Construction, Commissioning & Start-up,
and inspection of offshore and onshore projects for FPSO vessels, Oil Production Platforms, Exploration
Fields Thermal projects and Nuclear Projects in India . Oversee main Contractor development and
implementing of a Project specific Completion Strategy, Mechanical Completion, Pre-commissioning,
Commissioning &Hook-up, RFO (Ready for Operation) and Offshore Construction strategies.
In addition, I offer excellent skills, which have proven to be a critical asset in driving operations during the
current associations. These qualities, combined with my dedication and tireless work ethic, should enable
me to make a positive impact at your organization.
Enclosed is a copy of my resume for your review. I would welcome an opportunity to discuss your needs and
objectives and the possibility of working together to meet them. Thank you for your time and consideration.
Yours sincerely,
Vinu
Enclosure: Resume
Application for the Post of QA QC Professionals
Page 2 of 7
Vinu Ramasamy
Contact No.: +919443543842, +971503204811
E-mail:harinigayathri2002@yahoo.co.in, vinu.ramasamy@gmail.com
DOB:04-12-1969 Age:47 Yrs,
Passport Number: Z 3926245 Issued:01-06-2016 Expiry:31-05-2026
S/O G.Ramasamy,29&31, Kanthan street, Shenoy Nagar, Chennai-600030,TN, India
1. Post Diploma in Plant Maintenance ,State Board of Technical Education 1991-92 75%(Full time 1-1/2 Yrs)
2. Diploma in Mechanical Engineering,State Board of Technical Education 1985-89 69% (Full time 3 Yrs)
3. Bachelor of Technology-Mechanical ( Addl. Knowledge Only-ContinuedBTECH* by distance Education)
4. CSWIP 3.2.2 Senior Welding Inspector from TWI, UK (Cert. No. 71569)
5. Certified LEAD AUDITOR of Quality Managment System (ISO 9001:2008)
6. AWS-Senior Certified welding inspector (Cert. No. 02070068)
7. European welding specialist Diploma from European Welding Federation
8. Non Destructive testing RT,UT,MT,PT Level-II of ASNT
9. Diploma in Auto CADD
10. Valid Light Driving License in India & UAE;Also Valid Defence driving License issued by GASCO
Apprd.Agency
11. Offshore Sea survival Training
12. H2s Induction Training
13. Helicopter Underwater Escape Training
Synopsis
 Over24 years of experience in Oil , Gas &LNG Industry in Construction & Commissioning activities dealt
withQuality Assurance,CONSTRUCTION, INSPECTION , PRE-COMMISSIONING ,
COMMISSIOINING&START-UPof FPSO VESSELS, Onshore Production Facilities, Onshore Gas Development
Plants, Ethylene Expansion Plants,Sulphur Granulation Plant, Offshore Platforms, Thermal Projects & Nuclear
projects.
Summary of Experience
 Employed for over 24 years in the onshore & offshore construction& commissioning industry in client,
contractor departments. Implementing Quality Systems, reviewing and writing plans and procedures,
Supervising Mechanical, Piping & QC systems. Working to Construction Drawings and Pipeline Isometric
Drawings. Dimensional Inspection, Weld Procedures, Witness of Mechanical Tests, Parameter checks, NDT
Coordination, Line Punching Out, Test Pack System clearances, Punch list, Pressure Testing, Reviewing and
Approving Final Documentation and Certification. Preparation of Necessary documents required for pre-
commissioning, commissioning and start-up activities in the field.
 Recently worked as a Deputy Quality Manager,with Petrofac Oman for BP Khazzan
Project.with 30 QA/QC Engineers & InspectorsEarlier, I have worked as aQA/QC Team Leader, for
GASCO HSGP Project, Leading QC Team of Administratively & functionally Resolving technical issues ,
Active Participating of PMTC, QA QC ,Weekly progress meetings, Conducting &participating company
technical compliance audits for contractor, Stage wise QAQC requirements as per contract documents,
Contractor’s QC -CV approval as per the company contractual requirements, Reviewing of vendor &
contractor documents of ITP’S, Method statements, FAT, Quality Manuals, Welding Book(PQR,WPS),
vendor inspection activities, Attending Pre-Inspection Meetings(PIM), Vendor Inspection Co-ordinations
with TPI, Approving of TPI -CV ‘s, Reviewing of TPI Reports, Vendor’s Auditing ,Inspection of SEET
Sulphur Pipelines, Fuel GAS, Nitrogen & GRE Pipelines, Material Receiving Inspection, Mechanical
Equipment Erection, Final Walk down of Tanks , Reviewing of DCA & FCN, Material document review in
conjunction with code and specification, Ensuring compliance of all EPC activities with applicable GASCO
Design General Specifications (DGS) and codes & issuing NCR if any noncompliance with project
requirements
 On hands experience in Pressure Vessels, Columns of various capacities in field ofRefurbishment,
Inspection , NDT, As-Built Pit Mapping, and in the field of Fabrication, Structures, piping, instrument
tubing, underground piping, with Holiday detections and coordinating with Third Party Inspectors, Vendors
and NDT professionals.
 Inspection ofInternalRiser Mooring turret with all Piping and structural activities including Hydro/ Pneumatic
test, dryingwitnessing, and reinstatements.
 NDT witnessing, RT Film interpretation for all Weldments Including Pressure vessels, piping, structures,storage
tanks etc.
 Preparation of Post Weld Heat treatment procedure, witnessing and chart verifications.
Application for the Post of QA QC Professionals
Page 3 of 7
 Good working knowledge of all common welding processes used within the industry, Including manual, semi
automatic and automatic processes use in precision manufacture of pressure Piping systems, Tank constructions,
pipelines, pressure vessel inspection, heavy fabrication and general construction Ability to work unsupervised and
maintain Full traceability and document control for individual projects.
 As- Built Isometric Drawing and P&ID preparation, test pack preparation, dossier preparations, final certifications.
 Experienced in full project quality control surveillance from start up to final project close out.
 Experienced at senior clients inspection Engineer level in the quality control offshore fabrication, hook-up works,
riser-tie in joints, structural, hydro testing, pressure vessel repair works, painting inspections in well head process,
living platforms, piping fabrications and erections, jackets, drilling deck, boat landing, bridges, sub sea piping, riser
pipe etc.
 Indicator bolt tightening with 0.05 tolerance and stretch calculations,
 Inspection of Duplex stainless and other piping’s of U/G ,GRE piping’s, Ducts, Dampers, Equipment attachment
welding, steel structures, holiday detection of FBE coatings , tape wrappings , alignment of pumps & motors, HVAC
piping’s as per client requirements.
 On hands experience in Third party inspection activities of all mechanical, piping, welding, NDT, Structures,
pressure vessels storage tanks etc.
 Preliminary Designing Of Nuclear Shells, Dished Ends, Heat Exchanger Components And Nozzles, Drafting Of
Manufacturing And Engineering Drawings For Pressure Vessels And Heat Exchangers In Nuclear Engineering
Department With The Aid Of AutoCAD Material List Preparation, Inspection Of Nozzles Fit-Up, Welding With Welding
Procedure Specification, Claddings.
 The Inspection Of Valves, Seats, Seat Rings, Stems, Bonnet & Body, As Per Client Requirements, Stellite Welding
Inspection Of Seat And Wedge Weldings, RT Film Interpretation, And Submersible Pump Inspection.
 Developing Procedures, Manuals, Method Statements, Quality Plans, and Company Standards & Practices in
accordance with International Codes & Standards and Client specifications
 Inspection Of Structural Beams, Bracings Box Columns, Ducts, Dampers, Bowl Mills, Nuclear Dished End With The
Shells Fit-Up, Welding Inspections With The Pre Heat And Post Heat Treatments As Per Welding Procedure
Specification And Client Requirements.
 Ability toComprehensively review the project quality requirements and convert them into QC documents such
as QC Plan, Welding Procedure, Method Statements, Technical Delivery Conditions for materials, assign & lead
a team of QC Inspectors, review the dossier, Carryout physical inspection on all pressure retaining items,
offshore structures in accordance with drawings, codes & specifications.
 Fully familiar with the requirements and control procedures for the welding of common steel grades, high strength
alloy steel, stainless steel , Inconel and duplex steels.
 Good working knowledge of all common welding processes used within the industry, Including manual, semi
automatic and automatic processes use in precision manufacture of pressure Piping systems, Tank constructions,
pipelines, pressure vessel inspection, heavy fabrication and general construction.
 Ability to work unsupervised and maintain Document control & Full traceability for individual projects.
 Good working knowledge of international codes and specification.
 Basics of Electrical works of cable tray installation works, cable terminations etc.
 Basic knowledge of Civil works of earth works, foundations for vessel installations , form works and shutter works
structural steel works and concrete pour , ensure concrete materials, delivered on site as per qc requirements .
 Structural Inspections involved
Key Accomplishments
 Independently handled of, Inspection and repairing of corroded vessels (Coded ) of Dehydrators,
Desalters, Degassers, Knock out drums, Separators and Heat Exchangers- corrosion Investigation & pit
mapping(Total 24 vessels) in ‘A0” size drawings, repair weldings carried out in shell, Dished ends,
And internals as per repair procedures, I.T.P with SHELL team approval & AI consultation.
DOMAIN EXPERTISE
 To co-ordinate, monitor, inspect the Discipline Field activities for the erection, installation and commissioning
of staticequipments in accordance with Vendor equipment design and Specifications.
Application for the Post of QA QC Professionals
Page 4 of 7
 To ensure that the field activities for Piping and Mechanical are executed to meet all the requirements as laid
down in project Specifications, Drawings, Procedures, Safety and Quality documents.
 Preparation of Equipment data sheets for vendor enquiry and Support vendor shop inspection activities.
 Supervise and review Engineering Contractor documentation during the execution of detailed design,
procurement and, in a later stage, construction activities, ensuring the quality and cost control of the works
according to the contract requirements, and guaranteeing that the project targets (timing, cost and quality)
are correctly met.
 Review and raise RFI, NCR, FCN, and SCN of P& IDs for rotating/static equipment in lieu with site survey
reports.
 Ensures that Hook-up and commissioning activities as per standards & specifications in FPSO, onshore &
offshore production platforms.
CAREER CONTOUR
November 2015 till June 2016: Worked as a Deputy Quality Manager with Petrofac Oman for
their Central Processing Facilities BP-Khazzan Project. Leading 30 QA/ QC Engineers &
Inspectors, Conducting Meetings with Company, Sub-contractors ,& Participating Leads Meetings,
Review & follow-ups of QCP's, ITP's, for the approvals. Mitigating technical Issues, focusing Highest
Quality to meet with target dates, NCR's, SR's Action Tracker follow -ups weekly basis for closing within
stipulated period.
1)Feb 2012 till Oct 2014:QA/QC Team Leader Intertek Global Limited Seconded to GASCO,
UAE, leading team of 24 Inspectors & Engineers. Administratively & functionally Resolving technical
issues , Active Participating of PMTC, QA QC ,Weekly progress meetings, Conducting &participating
company technical compliance audits for contractor, Stage wise QAQC requirements as per contract
documents, Contractor’s QC -CV approval as per the company contractual requirements, Reviewing of
vendor & contractor documents of ITP’S, Method statements, FAT, Quality Manuals, Welding
Book(PQR,WPS), vendor inspection activities, Attending Pre-Inspection Meetings(PIM), Vendor
Inspection Co-ordinations with TPI, Approving of TPI -CV ‘s, Reviewing of TPI Reports, Vendor’s
Auditing ,Inspection of SEET Sulphur Pipelines, Fuel GAS, Nitrogen & GRE Pipelines, Material Receiving
Inspection, Mechanical Equipment Erection, Final Walk down of Tanks , Reviewing of DCA & FCN,
Material document review in conjunction with code and specification, Ensuring compliance of all EPC

activities with applicable GASCO Design General Specifications (DGS) and codes & issuing NCR if any
noncompliance with project requirements
Overall responsibility for Quality management across multiple sites of HSGP Project, Overseeing all
Quality assurance and Quality control activities for Multiple sites of project covering Procurement ,
Construction , Inspection/ Testing and Commissioning phases, Effective design & implementation of the
Quality Management System in accordance with applicable standard. Responsible for technical
assistance and control of Standard Quality and Operating procedures across EPC Management of Non
conformity process, Implement corrective and Preventive action & monitor its effectiveness Shared
cross-functionally. Provide assistance to Project management team for the implementation of the Project
QMS by contractors, subcontractors and vendors covering management, engineering, procurement,
construction and commissioning activities. Conduct Quality Audit/ Assessments (Internal and external)
and manage multi-discipline QA/ QC teams, Experience in Quality Management in all the EPC phases of
oil and gas projects, Technically sound in QA/ QC & also have an experience for working with
international clients.

2)Mar 2009 – Dec 2011 Lead QA/QC, Piping, StructuralEngineer- SPIE-OGS -Salman offshore-
Iran(Seconded to & worked with/ on behalf of PETRO IRAN (Government of
IRAN)
 Preparation of Pre-Commissioning & Commissioning Dossiers for Start-up operations.
 Preparation & Resolving NCR’s, TQ issues with the client with respect to design and engineering concerns.
 Vendor assistance for initial start up and commissioning activities.
 Preparation of Master Punch lists and progress reports for all disciplines.
 Reviewing of Commissioning Test Procedures and test plans required for commissioning.
 Preparation of Material Status Index, Procurement of shortage material required for Start-up.
 Hydro-testing & Leak-testing of piping in the platform with QC activities.
 Preparation of Job Hazard Analysis & Risk Assessment for Start-up.
 Modification works of piping , As-Built preparations
 Reviewing of MC, RFC, Commissioning Dossiers & preparation, clearing of comments.
Application for the Post of QA QC Professionals
Page 5 of 7
 Colour coding verifications with directions as per P&ID.
 Insulation both (PP, Hot) verifications,
 Preparation activities, procedure review of hot tapping.
 Reviewing of all contractors onshore NCR’s, TQ’s closures & addressing to client for the deviations with
project requirements.
 Handled the 7 (seven) offshore platform Hook up, pre-commissioning, commissioning activities as a
Supervisory role for 5 (five) Field QC Engineers.
Packages Inspected for Commissioning & Start-up:
Gas Export Facilities, Methanol-Corrosion-Chemical-Produced water treatment Packages, Glycol
Regeneration Packages, HVAC system, Fuel Gas treatment Package, Deluge skid, potable water &
Sewage treatment package, Pig Launchers, HP & LP Flare Packages,
3)OCT2007 to Feb 2009SPIE-OGS
 Worked as a Welding Engineer –(Seconded to & worked withStat oil-Norwegian Oil
Company, SouthPars)-SPIE-OGS, Seconded to Stat oil, Norwegian Oil Company for South Pars
Offshore projects, Iran Offshore.
 Performed their Hook-Up works of Piping, structural’s Flare lines.
 Risk/failure analysis of existing onshore constructions, rectification of weldolet’s in Inconel claded lines > more
than 60% of weldolet’s has been identified with LOP,LOF, Oxidized and Piping Butt welds were welded without
purging, of all of which has been cut and re-welded with re-commendations of codes and specifications.
 Preparing Surveillance Report against the any deviation in the sub-contractor work from the Project
specification and following up to close out the issue
 Reviewing of ITP & Method of Statements as per the requirement of Project specifications
 Following up OWL (Outstanding Work List) which was prepared by Vendor to close -out at the site.
 Witnessing welder qualification tests preparation & issued of welder Certificates and ID Cards for more
than 100 welders according to the relevant codes and requirements.
3)OCT 2005 to SEP 2007: Single Buoy Moorings (SBM), UAE.(Client: AGIP KCO, Italy)
 Worked as a Senior Piping Inspector of constructing Barge for Chevron FRADE Brazil Upstream
project.
 AGIP KCO, Kashagan Flash gas Compression Barges-FPSO’S - 3 Nos., Inspection of piping fabrication and
erection, Inspection of structure’s fabrication & erection, Film interpretation, NDE witness, Final Punch listings&
clearing, Hydro/Pneumatic Testing, re instatement witness ,As-Built drawings preparation, test pack review &
approvals, of Barges topsides and below deck.
4) JUNE 2005 TO SEP 2005:OCEANEERING, UAE(Client: Wood side Australian Energy)
 Worked as a Senior Welding Inspector for SINGLE BUOY MOORINGS, Jebel Ali,UAE, ForWOOD
SIDE AUSTRALIAN ENERGY.
 Inspection of Riser mooring internalturret piping’s, Punch List creation, and clearing of structures, Piping’s, Hydro
& Pneumatic testing witness, flushing, drying witness, Test pack preparation, review and approvals,
 Liaising with Design Consultant & Internal Departments on Mechanical & Piping issues, Ensure that all
construction checks are witnessed and complete Where applicable ensure that commissioning is carried
out as described under Onshore/Offshore commissioning procedures/manual/acceptance criteria as well
as Commission and Facilities Handover Procedure
5) FEB2005 TO APRIL 2005:Worked as Senior Welding Inspector-OCEANEERING, UAE. (Client:OXY-QATAR)
 Occidental Petroleum NPCC-OXY –IDD EL SHARGI Oil field Projects, IS-Q08 & IS-U10
Platforms,Qatar
 Inspection of HOOK UP activities in Offshore piping,Riser Tie –ins,Structural Inspection ,Painting Inspection for all
Structural, piping and risers,hydro testing in two platforms,Material Traceability
6) MARCH 2004 TO DEC 2004: Worked as Senior Welding Inspector-OCEANEERING(Client:NPCC &SHELL Iran
offshore, Iran)
 Inspection of HOOK – UP activities in offshore piping, Riser Tie- ins fit-up, welding& NDE witness, Structural
WorksExperienced in survey of mechanical installation to verify mechanical integrity in accordance with
specification and good engineering practice.
 Inspection and repairing of corroded vessels (Coded ) of Dehydrators, Desalters, Degassers,
Knock out drums, Separators and Heat Exchangers- corrosion Investigation & pit mapping
(Total 24 vessels) in ‘A0” size drawings, repair weldings carried out in shell, Dished ends,
and internals as per repair procedures ,I.T.P & with SHELL & AI consultation.
7)NOV. 2003 TO FEB2004:
 Worked as Senior Welding Inspector OCEANEERING,(Client:NPCC- TAKREER – UAE)
 Inspections of two (29M Diameter x 20M Height) tank construction, Refurbishment of Existing tanks,Pressure
Vessel Fabrication,Piping’s& Pipelines to Jetty Inspection, Relevant NDT Testing’s, Pressure (Pneumatic /hydro
testing) witness and re-instatements.
8) MAR2003 TO NOV. 2003:Worked as Senior Welding Inspector- OCEANEERING(Client:NPCC- SHELL –NIOC IRAN
ONSHORE)
Application for the Post of QA QC Professionals
Page 6 of 7
 Seconded to TECHNIP/NPCC project. This project involves fabrication erection and
installation of 2 well head platforms, 3 process platforms, 2 living quarters’ platforms, 5 jackets, 4
bridges including fabrication and erection of related piping/vessels/Tanks. The total capital investment
for this project is around US$830 million.
 Inspection of 4nos. of bridges meant for use between platforms, mechanical activities in the living quarters
platforms, Fabrication activities of pressure vessels &tanks, fabrication and erection activities of all decks of 2well
head platforms,2 living quarters platform, all related piping activities in the above platforms, Offshore jacket,
riser pipe, Sub-Sea pipe fabrication, punch listing ,hydro and pneumatic test witness with clients and flushing s
as per clients requirements

Work Experience - NIGERIA
9) FEB-2001 to FEB2002:TechintCimimontubi, Italian co., Bonny Island, Port Harcourt, Nigeria
 (Clients: TSKJ Joint venture(Technip, Snamprogetti, Kellogg& Japan General Corporation) for
Nigeria Liquefied Natural Gas Expansion Project –Train 3& 4)
 Worked as a Senior Piping, Welding & NDE Inspector
 Inspection of Piping & Welding Inspections, Witness welder qualification tests, pressure testing, Heat treatment
chart review, Preparation, &resolving Non conformance reports & corrective actions. Full traceability of piping,As-
Built drawings for the whole projects.
10) JUNE ‘99 to JULY 2000. Consolidated Contractors International Company (CCIC) UAE(Clients: Bechtel
&Technip JV)
 Bechtel / Technip Joint Venture for ADNOC Onshore Gas Development Project Phase-II,UAE
 Senior Quality Control Inspector (Piping & Welding)
 Inspection of all U/G &Field piping, Punch listing,Hydro/ pneumatic Pressure test witness with clients & Third
party, Flushing, reinstatement witness,Interpretation of RT films, Review of test packs & As- Built drawings
Preparations.
11) Sep. ‘97 to JULY ’98: Consolidated Contractors International Company (CCIC), KSA.(Client: Bechtel &
Aramco)
 Bechtel, USA for their AramcoShay bahproducing facilities.
 Quality Control Inspector (Piping & Welding)
 Inspection of Duplex stainless, U/G ,GRE piping, Ducts, Dampers, Equipment attachment welding,Steel
structures,Holiday detection of FBE coatings , tape wrappings ,Alignment of pumps & motors ,HVAC piping as
per client requirements.
12) FEB. – 1997 to JUNE –1997: Consolidated Contractors International Company (CCIC) KuwaitClient:
Brown & Root International Inc. (Halliburton Group)
 Brown & Root International Inc. (Halliburton Group) U.S.A. for their Equate Ethylene Project
 Worked as Quality Control Inspector (Piping & Welding)
 Inspection of structures, equipment attachment weldings, & all related piping’s fabrication &erection,Indicator
bolt tightening with 0.05 tolerance and stretch calculations, Punch list preparation & clearing,Hydro/ pneumatic
&flushing’s as per client requirements.
13) SEP. –1995 to JUNE –1996 Consolidated Contractors International Company,Qatar (Client:
Technip& KTI Netherland)
 Technip, France & KTI, Nether Lands for their QAPCO Ethylene Expansion Project
 Worked as Quality Control Inspector (Piping & Welding)
 Inspection of piping’s in fabrication & erection,Punch list preparation & clearing, Witness of Hydro, pneumatic
testing’s, Flushing & reinstatements, Welding consumable control,Test pack preparations, review & Approval
Material Traceability
14) JUNE – 1994 to MAY – 1995: Consolidated Contractors International Company, UAE (Client:
Bechtel &Technip JV)
 Bechtel / Technip Joint Venture for their ADNOC Onshore Gas Development Project Phase-I
 Worked as NDT Co-ordinator/Inspector
 Interpretation Of Radiographic Films As Per ANSI B31.3, Inspection Of Weldments By Visual Inspection,
Ultrasonic Testing Magnetic Particle Inspection And Dye Penetrant Inspection For The Carbon Steels, Low
Temperature Carbon Steels, Stainless Steels, Alloy Steels Pipings, Structural Steel Weldings And Equipment
Weldings.Liaison with third party Inspectors of LLOYDS REGISTER
Experience in INDIA:
15) FEB –1994 to APRIL –1994:KSB PUMPS & VALVES Ltd.,
 Worked as a Junior Welding Engineer
 Responsible for the Inspection Of Valves, Seats, Seat Rings, Stems, Bonnets& Body, As Per Client
Requirements& codes, Stellite Welding Inspection Of Seats And Wedge Weldings, RT Film Interpretation,
Submersible Pump Inspection.

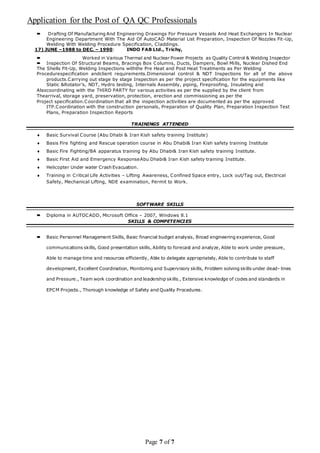

16) February –1992 to February – 1993: BHARAT HEAVY ELECTRICALS LIMITED (BHEL, TRICHY)
 Worked as Diploma Engineer Trainee
 Preliminary Designing Of Nuclear Shells, Dished Ends, Heat Exchanger Components And Nozzles,
Application for the Post of QA QC Professionals
Page 7 of 7
 Drafting Of Manufacturing And Engineering Drawings For Pressure Vessels And Heat Exchangers In Nuclear
Engineering Department With The Aid Of AutoCAD Material List Preparation, Inspection Of Nozzles Fit-Up,
Welding With Welding Procedure Specification, Claddings.
17) JUNE –1988 to DEC. – 1990: INDO FAB Ltd., Trichy,
 Worked in Various Thermal and Nuclear Power Projects as Quality Control & Welding Inspector
 Inspection Of Structural Beams, Bracings Box Columns, Ducts, Dampers, Bowl Mills, Nuclear Dished End
The Shells Fit-Up, Welding Inspections withthe Pre Heat and Post Heat Treatments as Per Welding
Procedurespecification andclient requirements.Dimensional control & NDT Inspections for all of the above
products.Carrying out stage by stage Inspection as per the project specification for the equipments like
Static &Rotator’s, NDT, Hydro testing, Internals Assembly, piping, Fireproofing, Insulating and
Alsocoordinating with the THIRD PARTY for various activities as per the supplied by the client from
Thearrival, storage yard, preservation, protection, erection and commissioning as per the
Project specification.Coordination that all the inspection activities are documented as per the approved
ITP.Coordination with the construction personals, Preparation of Quality Plan, Preparation Inspection Test
Plans, Preparation Inspection Reports
TRAININGS ATTENDED
 Basic Survival Course (Abu Dhabi & Iran Kish safety training Institute)
 Basis Fire fighting and Rescue operation course in Abu Dhabi& Iran Kish safety training Institute
 Basic Fire Fighting/BA apparatus training by Abu Dhabi& Iran Kish safety training Institute.
 Basic First Aid and Emergency ResponseAbu Dhabi& Iran Kish safety training Institute.
 Helicopter Under water Crash Evacuation.
 Training in Critical Life Activities – Lifting Awareness, Confined Space entry, Lock out/Tag out, Electrical
Safety, Mechanical Lifting, NDE examination, Permit to Work.
SOFTWARE SKILLS
 Diploma in AUTOCADD, Microsoft Office – 2007, Windows 8.1
SKILLS & COMPETENCIES
 Basic Personnel Management Skills, Basic financial budget analysis, Broad engineering experience, Good
communications skills, Good presentation skills, Ability to forecast and analyze, Able to work under pressure,
Able to manage time and resources efficiently, Able to delegate appropriately, Able to contribute to staff
development, Excellent Coordination, Monitoring and Supervisory skills, Problem solving skills under dead- lines
and Pressure., Team work coordination and leadership skills., Extensive knowledge of codes and standards in
EPCM Projects., Thorough knowledge of Safety and Quality Procedures.

Vinu cv august 16

  • 1.
    Application for thePost of QA QC Professionals Page 1 of 7 Vinu Ramasamy Contact No.: +919443543842,UAE:+971503204811, E-mail: harinigayathri2002@yahoo.co.in Vinu.ramasamy@gmail.com skype ID: harinigayathri https://in.linkedin.com/pub/ramasamy-vinu/3b/793/7b7 Dated: August 2016 To, The HR Manager, It was with great interest that I would like to apply for a Position of Quality Manager, Inspection Engineer,Lead QA/QC Engineer or Team Leader or suitable onein your esteemed organization. Review of my credentials will confirm that I am capable of serving as a catalyst for achieving objectives and organic growth through effective contributions. Recently Worked as a Deputy Quality Manager, with Petrofac Oman for BP Khazzan Project with 30 QA/QC Engineers & Inspectors.Earlier I have worked as a QA/QCTeam Leader for GASCO, which covers of Overall responsibility for Quality management across multiple sites of HSGP Project, Overseeing all Quality assurance and Quality control activities for Multiple sites of project covering Procurement , Construction , Inspection/ Testing and Commissioning phases, Effective design & implementation of the Quality Management System in accordance with applicable standard. Responsible for technical assistance and control of Standard Quality and Operating procedures across EPC Management of Non conformity process, Implement corrective and Preventive action & monitor its effectiveness Shared cross-functionally. Provide assistance to Project management team for the implementation of the Project QMS by contractors, subcontractors and vendors covering management, engineering, procurement, construction and commissioning activities. Conduct Quality Audit/ Assessments (Internal and external) and manage multi-discipline QA/ QC teams, Experience in Quality Management in all the EPC phases of oil and gas projects, Technically sound in QA/ QC & also have experience for working with international clients.Administratively & functionally Resolving technical issues , Active Participating of PMTC, QA QC ,Weekly progress meetings, Conducting &participating company technical compliance audits for contractor, Stage wise QAQC requirements as per contract documents, Contractor’s QC -CV approval as per the company contractual requirements,Reviewing of vendor& contractor documents of ITP’S, Method statements, FAT, Quality Manuals, Welding Book(PQR,WPS), vendor inspection activities, Attending Pre- Inspection Meetings(PIM), Vendor Inspection Co-ordinations with TPI, Approving of TPI -CV ‘s, Reviewing of TPI Reports, Vendor’s Auditing ,Inspection of SEET Sulphur Pipelines, Fuel GAS, Nitrogen & GRE Pipelines, Material Receiving Inspection, Mechanical Equipment Erection, Final Walk down of Tanks , Reviewing of DCA & FCN, Material document review in conjunction with code and specification, Ensuring compliance of all EPC activities with applicable GASCO Design General Specifications (DGS) and codes& issuing NCR if any noncompliance with project requirements. I possess over24years of experience in oil, gas and LNG sectors in Construction, Commissioning & Start-up, and inspection of offshore and onshore projects for FPSO vessels, Oil Production Platforms, Exploration Fields Thermal projects and Nuclear Projects in India . Oversee main Contractor development and implementing of a Project specific Completion Strategy, Mechanical Completion, Pre-commissioning, Commissioning &Hook-up, RFO (Ready for Operation) and Offshore Construction strategies. In addition, I offer excellent skills, which have proven to be a critical asset in driving operations during the current associations. These qualities, combined with my dedication and tireless work ethic, should enable me to make a positive impact at your organization. Enclosed is a copy of my resume for your review. I would welcome an opportunity to discuss your needs and objectives and the possibility of working together to meet them. Thank you for your time and consideration. Yours sincerely, Vinu Enclosure: Resume
  • 2.
    Application for thePost of QA QC Professionals Page 2 of 7 Vinu Ramasamy Contact No.: +919443543842, +971503204811 E-mail:harinigayathri2002@yahoo.co.in, vinu.ramasamy@gmail.com DOB:04-12-1969 Age:47 Yrs, Passport Number: Z 3926245 Issued:01-06-2016 Expiry:31-05-2026 S/O G.Ramasamy,29&31, Kanthan street, Shenoy Nagar, Chennai-600030,TN, India 1. Post Diploma in Plant Maintenance ,State Board of Technical Education 1991-92 75%(Full time 1-1/2 Yrs) 2. Diploma in Mechanical Engineering,State Board of Technical Education 1985-89 69% (Full time 3 Yrs) 3. Bachelor of Technology-Mechanical ( Addl. Knowledge Only-ContinuedBTECH* by distance Education) 4. CSWIP 3.2.2 Senior Welding Inspector from TWI, UK (Cert. No. 71569) 5. Certified LEAD AUDITOR of Quality Managment System (ISO 9001:2008) 6. AWS-Senior Certified welding inspector (Cert. No. 02070068) 7. European welding specialist Diploma from European Welding Federation 8. Non Destructive testing RT,UT,MT,PT Level-II of ASNT 9. Diploma in Auto CADD 10. Valid Light Driving License in India & UAE;Also Valid Defence driving License issued by GASCO Apprd.Agency 11. Offshore Sea survival Training 12. H2s Induction Training 13. Helicopter Underwater Escape Training Synopsis  Over24 years of experience in Oil , Gas &LNG Industry in Construction & Commissioning activities dealt withQuality Assurance,CONSTRUCTION, INSPECTION , PRE-COMMISSIONING , COMMISSIOINING&START-UPof FPSO VESSELS, Onshore Production Facilities, Onshore Gas Development Plants, Ethylene Expansion Plants,Sulphur Granulation Plant, Offshore Platforms, Thermal Projects & Nuclear projects. Summary of Experience  Employed for over 24 years in the onshore & offshore construction& commissioning industry in client, contractor departments. Implementing Quality Systems, reviewing and writing plans and procedures, Supervising Mechanical, Piping & QC systems. Working to Construction Drawings and Pipeline Isometric Drawings. Dimensional Inspection, Weld Procedures, Witness of Mechanical Tests, Parameter checks, NDT Coordination, Line Punching Out, Test Pack System clearances, Punch list, Pressure Testing, Reviewing and Approving Final Documentation and Certification. Preparation of Necessary documents required for pre- commissioning, commissioning and start-up activities in the field.  Recently worked as a Deputy Quality Manager,with Petrofac Oman for BP Khazzan Project.with 30 QA/QC Engineers & InspectorsEarlier, I have worked as aQA/QC Team Leader, for GASCO HSGP Project, Leading QC Team of Administratively & functionally Resolving technical issues , Active Participating of PMTC, QA QC ,Weekly progress meetings, Conducting &participating company technical compliance audits for contractor, Stage wise QAQC requirements as per contract documents, Contractor’s QC -CV approval as per the company contractual requirements, Reviewing of vendor & contractor documents of ITP’S, Method statements, FAT, Quality Manuals, Welding Book(PQR,WPS), vendor inspection activities, Attending Pre-Inspection Meetings(PIM), Vendor Inspection Co-ordinations with TPI, Approving of TPI -CV ‘s, Reviewing of TPI Reports, Vendor’s Auditing ,Inspection of SEET Sulphur Pipelines, Fuel GAS, Nitrogen & GRE Pipelines, Material Receiving Inspection, Mechanical Equipment Erection, Final Walk down of Tanks , Reviewing of DCA & FCN, Material document review in conjunction with code and specification, Ensuring compliance of all EPC activities with applicable GASCO Design General Specifications (DGS) and codes & issuing NCR if any noncompliance with project requirements  On hands experience in Pressure Vessels, Columns of various capacities in field ofRefurbishment, Inspection , NDT, As-Built Pit Mapping, and in the field of Fabrication, Structures, piping, instrument tubing, underground piping, with Holiday detections and coordinating with Third Party Inspectors, Vendors and NDT professionals.  Inspection ofInternalRiser Mooring turret with all Piping and structural activities including Hydro/ Pneumatic test, dryingwitnessing, and reinstatements.  NDT witnessing, RT Film interpretation for all Weldments Including Pressure vessels, piping, structures,storage tanks etc.  Preparation of Post Weld Heat treatment procedure, witnessing and chart verifications.
  • 3.
    Application for thePost of QA QC Professionals Page 3 of 7  Good working knowledge of all common welding processes used within the industry, Including manual, semi automatic and automatic processes use in precision manufacture of pressure Piping systems, Tank constructions, pipelines, pressure vessel inspection, heavy fabrication and general construction Ability to work unsupervised and maintain Full traceability and document control for individual projects.  As- Built Isometric Drawing and P&ID preparation, test pack preparation, dossier preparations, final certifications.  Experienced in full project quality control surveillance from start up to final project close out.  Experienced at senior clients inspection Engineer level in the quality control offshore fabrication, hook-up works, riser-tie in joints, structural, hydro testing, pressure vessel repair works, painting inspections in well head process, living platforms, piping fabrications and erections, jackets, drilling deck, boat landing, bridges, sub sea piping, riser pipe etc.  Indicator bolt tightening with 0.05 tolerance and stretch calculations,  Inspection of Duplex stainless and other piping’s of U/G ,GRE piping’s, Ducts, Dampers, Equipment attachment welding, steel structures, holiday detection of FBE coatings , tape wrappings , alignment of pumps & motors, HVAC piping’s as per client requirements.  On hands experience in Third party inspection activities of all mechanical, piping, welding, NDT, Structures, pressure vessels storage tanks etc.  Preliminary Designing Of Nuclear Shells, Dished Ends, Heat Exchanger Components And Nozzles, Drafting Of Manufacturing And Engineering Drawings For Pressure Vessels And Heat Exchangers In Nuclear Engineering Department With The Aid Of AutoCAD Material List Preparation, Inspection Of Nozzles Fit-Up, Welding With Welding Procedure Specification, Claddings.  The Inspection Of Valves, Seats, Seat Rings, Stems, Bonnet & Body, As Per Client Requirements, Stellite Welding Inspection Of Seat And Wedge Weldings, RT Film Interpretation, And Submersible Pump Inspection.  Developing Procedures, Manuals, Method Statements, Quality Plans, and Company Standards & Practices in accordance with International Codes & Standards and Client specifications  Inspection Of Structural Beams, Bracings Box Columns, Ducts, Dampers, Bowl Mills, Nuclear Dished End With The Shells Fit-Up, Welding Inspections With The Pre Heat And Post Heat Treatments As Per Welding Procedure Specification And Client Requirements.  Ability toComprehensively review the project quality requirements and convert them into QC documents such as QC Plan, Welding Procedure, Method Statements, Technical Delivery Conditions for materials, assign & lead a team of QC Inspectors, review the dossier, Carryout physical inspection on all pressure retaining items, offshore structures in accordance with drawings, codes & specifications.  Fully familiar with the requirements and control procedures for the welding of common steel grades, high strength alloy steel, stainless steel , Inconel and duplex steels.  Good working knowledge of all common welding processes used within the industry, Including manual, semi automatic and automatic processes use in precision manufacture of pressure Piping systems, Tank constructions, pipelines, pressure vessel inspection, heavy fabrication and general construction.  Ability to work unsupervised and maintain Document control & Full traceability for individual projects.  Good working knowledge of international codes and specification.  Basics of Electrical works of cable tray installation works, cable terminations etc.  Basic knowledge of Civil works of earth works, foundations for vessel installations , form works and shutter works structural steel works and concrete pour , ensure concrete materials, delivered on site as per qc requirements .  Structural Inspections involved Key Accomplishments  Independently handled of, Inspection and repairing of corroded vessels (Coded ) of Dehydrators, Desalters, Degassers, Knock out drums, Separators and Heat Exchangers- corrosion Investigation & pit mapping(Total 24 vessels) in ‘A0” size drawings, repair weldings carried out in shell, Dished ends, And internals as per repair procedures, I.T.P with SHELL team approval & AI consultation. DOMAIN EXPERTISE  To co-ordinate, monitor, inspect the Discipline Field activities for the erection, installation and commissioning of staticequipments in accordance with Vendor equipment design and Specifications.
  • 4.
    Application for thePost of QA QC Professionals Page 4 of 7  To ensure that the field activities for Piping and Mechanical are executed to meet all the requirements as laid down in project Specifications, Drawings, Procedures, Safety and Quality documents.  Preparation of Equipment data sheets for vendor enquiry and Support vendor shop inspection activities.  Supervise and review Engineering Contractor documentation during the execution of detailed design, procurement and, in a later stage, construction activities, ensuring the quality and cost control of the works according to the contract requirements, and guaranteeing that the project targets (timing, cost and quality) are correctly met.  Review and raise RFI, NCR, FCN, and SCN of P& IDs for rotating/static equipment in lieu with site survey reports.  Ensures that Hook-up and commissioning activities as per standards & specifications in FPSO, onshore & offshore production platforms. CAREER CONTOUR November 2015 till June 2016: Worked as a Deputy Quality Manager with Petrofac Oman for their Central Processing Facilities BP-Khazzan Project. Leading 30 QA/ QC Engineers & Inspectors, Conducting Meetings with Company, Sub-contractors ,& Participating Leads Meetings, Review & follow-ups of QCP's, ITP's, for the approvals. Mitigating technical Issues, focusing Highest Quality to meet with target dates, NCR's, SR's Action Tracker follow -ups weekly basis for closing within stipulated period. 1)Feb 2012 till Oct 2014:QA/QC Team Leader Intertek Global Limited Seconded to GASCO, UAE, leading team of 24 Inspectors & Engineers. Administratively & functionally Resolving technical issues , Active Participating of PMTC, QA QC ,Weekly progress meetings, Conducting &participating company technical compliance audits for contractor, Stage wise QAQC requirements as per contract documents, Contractor’s QC -CV approval as per the company contractual requirements, Reviewing of vendor & contractor documents of ITP’S, Method statements, FAT, Quality Manuals, Welding Book(PQR,WPS), vendor inspection activities, Attending Pre-Inspection Meetings(PIM), Vendor Inspection Co-ordinations with TPI, Approving of TPI -CV ‘s, Reviewing of TPI Reports, Vendor’s Auditing ,Inspection of SEET Sulphur Pipelines, Fuel GAS, Nitrogen & GRE Pipelines, Material Receiving Inspection, Mechanical Equipment Erection, Final Walk down of Tanks , Reviewing of DCA & FCN, Material document review in conjunction with code and specification, Ensuring compliance of all EPC activities with applicable GASCO Design General Specifications (DGS) and codes & issuing NCR if any noncompliance with project requirements Overall responsibility for Quality management across multiple sites of HSGP Project, Overseeing all Quality assurance and Quality control activities for Multiple sites of project covering Procurement , Construction , Inspection/ Testing and Commissioning phases, Effective design & implementation of the Quality Management System in accordance with applicable standard. Responsible for technical assistance and control of Standard Quality and Operating procedures across EPC Management of Non conformity process, Implement corrective and Preventive action & monitor its effectiveness Shared cross-functionally. Provide assistance to Project management team for the implementation of the Project QMS by contractors, subcontractors and vendors covering management, engineering, procurement, construction and commissioning activities. Conduct Quality Audit/ Assessments (Internal and external) and manage multi-discipline QA/ QC teams, Experience in Quality Management in all the EPC phases of oil and gas projects, Technically sound in QA/ QC & also have an experience for working with international clients. 2)Mar 2009 – Dec 2011 Lead QA/QC, Piping, StructuralEngineer- SPIE-OGS -Salman offshore- Iran(Seconded to & worked with/ on behalf of PETRO IRAN (Government of IRAN)  Preparation of Pre-Commissioning & Commissioning Dossiers for Start-up operations.  Preparation & Resolving NCR’s, TQ issues with the client with respect to design and engineering concerns.  Vendor assistance for initial start up and commissioning activities.  Preparation of Master Punch lists and progress reports for all disciplines.  Reviewing of Commissioning Test Procedures and test plans required for commissioning.  Preparation of Material Status Index, Procurement of shortage material required for Start-up.  Hydro-testing & Leak-testing of piping in the platform with QC activities.  Preparation of Job Hazard Analysis & Risk Assessment for Start-up.  Modification works of piping , As-Built preparations  Reviewing of MC, RFC, Commissioning Dossiers & preparation, clearing of comments.
  • 5.
    Application for thePost of QA QC Professionals Page 5 of 7  Colour coding verifications with directions as per P&ID.  Insulation both (PP, Hot) verifications,  Preparation activities, procedure review of hot tapping.  Reviewing of all contractors onshore NCR’s, TQ’s closures & addressing to client for the deviations with project requirements.  Handled the 7 (seven) offshore platform Hook up, pre-commissioning, commissioning activities as a Supervisory role for 5 (five) Field QC Engineers. Packages Inspected for Commissioning & Start-up: Gas Export Facilities, Methanol-Corrosion-Chemical-Produced water treatment Packages, Glycol Regeneration Packages, HVAC system, Fuel Gas treatment Package, Deluge skid, potable water & Sewage treatment package, Pig Launchers, HP & LP Flare Packages, 3)OCT2007 to Feb 2009SPIE-OGS  Worked as a Welding Engineer –(Seconded to & worked withStat oil-Norwegian Oil Company, SouthPars)-SPIE-OGS, Seconded to Stat oil, Norwegian Oil Company for South Pars Offshore projects, Iran Offshore.  Performed their Hook-Up works of Piping, structural’s Flare lines.  Risk/failure analysis of existing onshore constructions, rectification of weldolet’s in Inconel claded lines > more than 60% of weldolet’s has been identified with LOP,LOF, Oxidized and Piping Butt welds were welded without purging, of all of which has been cut and re-welded with re-commendations of codes and specifications.  Preparing Surveillance Report against the any deviation in the sub-contractor work from the Project specification and following up to close out the issue  Reviewing of ITP & Method of Statements as per the requirement of Project specifications  Following up OWL (Outstanding Work List) which was prepared by Vendor to close -out at the site.  Witnessing welder qualification tests preparation & issued of welder Certificates and ID Cards for more than 100 welders according to the relevant codes and requirements. 3)OCT 2005 to SEP 2007: Single Buoy Moorings (SBM), UAE.(Client: AGIP KCO, Italy)  Worked as a Senior Piping Inspector of constructing Barge for Chevron FRADE Brazil Upstream project.  AGIP KCO, Kashagan Flash gas Compression Barges-FPSO’S - 3 Nos., Inspection of piping fabrication and erection, Inspection of structure’s fabrication & erection, Film interpretation, NDE witness, Final Punch listings& clearing, Hydro/Pneumatic Testing, re instatement witness ,As-Built drawings preparation, test pack review & approvals, of Barges topsides and below deck. 4) JUNE 2005 TO SEP 2005:OCEANEERING, UAE(Client: Wood side Australian Energy)  Worked as a Senior Welding Inspector for SINGLE BUOY MOORINGS, Jebel Ali,UAE, ForWOOD SIDE AUSTRALIAN ENERGY.  Inspection of Riser mooring internalturret piping’s, Punch List creation, and clearing of structures, Piping’s, Hydro & Pneumatic testing witness, flushing, drying witness, Test pack preparation, review and approvals,  Liaising with Design Consultant & Internal Departments on Mechanical & Piping issues, Ensure that all construction checks are witnessed and complete Where applicable ensure that commissioning is carried out as described under Onshore/Offshore commissioning procedures/manual/acceptance criteria as well as Commission and Facilities Handover Procedure 5) FEB2005 TO APRIL 2005:Worked as Senior Welding Inspector-OCEANEERING, UAE. (Client:OXY-QATAR)  Occidental Petroleum NPCC-OXY –IDD EL SHARGI Oil field Projects, IS-Q08 & IS-U10 Platforms,Qatar  Inspection of HOOK UP activities in Offshore piping,Riser Tie –ins,Structural Inspection ,Painting Inspection for all Structural, piping and risers,hydro testing in two platforms,Material Traceability 6) MARCH 2004 TO DEC 2004: Worked as Senior Welding Inspector-OCEANEERING(Client:NPCC &SHELL Iran offshore, Iran)  Inspection of HOOK – UP activities in offshore piping, Riser Tie- ins fit-up, welding& NDE witness, Structural WorksExperienced in survey of mechanical installation to verify mechanical integrity in accordance with specification and good engineering practice.  Inspection and repairing of corroded vessels (Coded ) of Dehydrators, Desalters, Degassers, Knock out drums, Separators and Heat Exchangers- corrosion Investigation & pit mapping (Total 24 vessels) in ‘A0” size drawings, repair weldings carried out in shell, Dished ends, and internals as per repair procedures ,I.T.P & with SHELL & AI consultation. 7)NOV. 2003 TO FEB2004:  Worked as Senior Welding Inspector OCEANEERING,(Client:NPCC- TAKREER – UAE)  Inspections of two (29M Diameter x 20M Height) tank construction, Refurbishment of Existing tanks,Pressure Vessel Fabrication,Piping’s& Pipelines to Jetty Inspection, Relevant NDT Testing’s, Pressure (Pneumatic /hydro testing) witness and re-instatements. 8) MAR2003 TO NOV. 2003:Worked as Senior Welding Inspector- OCEANEERING(Client:NPCC- SHELL –NIOC IRAN ONSHORE)
  • 6.
    Application for thePost of QA QC Professionals Page 6 of 7  Seconded to TECHNIP/NPCC project. This project involves fabrication erection and installation of 2 well head platforms, 3 process platforms, 2 living quarters’ platforms, 5 jackets, 4 bridges including fabrication and erection of related piping/vessels/Tanks. The total capital investment for this project is around US$830 million.  Inspection of 4nos. of bridges meant for use between platforms, mechanical activities in the living quarters platforms, Fabrication activities of pressure vessels &tanks, fabrication and erection activities of all decks of 2well head platforms,2 living quarters platform, all related piping activities in the above platforms, Offshore jacket, riser pipe, Sub-Sea pipe fabrication, punch listing ,hydro and pneumatic test witness with clients and flushing s as per clients requirements Work Experience - NIGERIA 9) FEB-2001 to FEB2002:TechintCimimontubi, Italian co., Bonny Island, Port Harcourt, Nigeria  (Clients: TSKJ Joint venture(Technip, Snamprogetti, Kellogg& Japan General Corporation) for Nigeria Liquefied Natural Gas Expansion Project –Train 3& 4)  Worked as a Senior Piping, Welding & NDE Inspector  Inspection of Piping & Welding Inspections, Witness welder qualification tests, pressure testing, Heat treatment chart review, Preparation, &resolving Non conformance reports & corrective actions. Full traceability of piping,As- Built drawings for the whole projects. 10) JUNE ‘99 to JULY 2000. Consolidated Contractors International Company (CCIC) UAE(Clients: Bechtel &Technip JV)  Bechtel / Technip Joint Venture for ADNOC Onshore Gas Development Project Phase-II,UAE  Senior Quality Control Inspector (Piping & Welding)  Inspection of all U/G &Field piping, Punch listing,Hydro/ pneumatic Pressure test witness with clients & Third party, Flushing, reinstatement witness,Interpretation of RT films, Review of test packs & As- Built drawings Preparations. 11) Sep. ‘97 to JULY ’98: Consolidated Contractors International Company (CCIC), KSA.(Client: Bechtel & Aramco)  Bechtel, USA for their AramcoShay bahproducing facilities.  Quality Control Inspector (Piping & Welding)  Inspection of Duplex stainless, U/G ,GRE piping, Ducts, Dampers, Equipment attachment welding,Steel structures,Holiday detection of FBE coatings , tape wrappings ,Alignment of pumps & motors ,HVAC piping as per client requirements. 12) FEB. – 1997 to JUNE –1997: Consolidated Contractors International Company (CCIC) KuwaitClient: Brown & Root International Inc. (Halliburton Group)  Brown & Root International Inc. (Halliburton Group) U.S.A. for their Equate Ethylene Project  Worked as Quality Control Inspector (Piping & Welding)  Inspection of structures, equipment attachment weldings, & all related piping’s fabrication &erection,Indicator bolt tightening with 0.05 tolerance and stretch calculations, Punch list preparation & clearing,Hydro/ pneumatic &flushing’s as per client requirements. 13) SEP. –1995 to JUNE –1996 Consolidated Contractors International Company,Qatar (Client: Technip& KTI Netherland)  Technip, France & KTI, Nether Lands for their QAPCO Ethylene Expansion Project  Worked as Quality Control Inspector (Piping & Welding)  Inspection of piping’s in fabrication & erection,Punch list preparation & clearing, Witness of Hydro, pneumatic testing’s, Flushing & reinstatements, Welding consumable control,Test pack preparations, review & Approval Material Traceability 14) JUNE – 1994 to MAY – 1995: Consolidated Contractors International Company, UAE (Client: Bechtel &Technip JV)  Bechtel / Technip Joint Venture for their ADNOC Onshore Gas Development Project Phase-I  Worked as NDT Co-ordinator/Inspector  Interpretation Of Radiographic Films As Per ANSI B31.3, Inspection Of Weldments By Visual Inspection, Ultrasonic Testing Magnetic Particle Inspection And Dye Penetrant Inspection For The Carbon Steels, Low Temperature Carbon Steels, Stainless Steels, Alloy Steels Pipings, Structural Steel Weldings And Equipment Weldings.Liaison with third party Inspectors of LLOYDS REGISTER Experience in INDIA: 15) FEB –1994 to APRIL –1994:KSB PUMPS & VALVES Ltd.,  Worked as a Junior Welding Engineer  Responsible for the Inspection Of Valves, Seats, Seat Rings, Stems, Bonnets& Body, As Per Client Requirements& codes, Stellite Welding Inspection Of Seats And Wedge Weldings, RT Film Interpretation, Submersible Pump Inspection. 16) February –1992 to February – 1993: BHARAT HEAVY ELECTRICALS LIMITED (BHEL, TRICHY)  Worked as Diploma Engineer Trainee  Preliminary Designing Of Nuclear Shells, Dished Ends, Heat Exchanger Components And Nozzles,
  • 7.
    Application for thePost of QA QC Professionals Page 7 of 7  Drafting Of Manufacturing And Engineering Drawings For Pressure Vessels And Heat Exchangers In Nuclear Engineering Department With The Aid Of AutoCAD Material List Preparation, Inspection Of Nozzles Fit-Up, Welding With Welding Procedure Specification, Claddings. 17) JUNE –1988 to DEC. – 1990: INDO FAB Ltd., Trichy,  Worked in Various Thermal and Nuclear Power Projects as Quality Control & Welding Inspector  Inspection Of Structural Beams, Bracings Box Columns, Ducts, Dampers, Bowl Mills, Nuclear Dished End The Shells Fit-Up, Welding Inspections withthe Pre Heat and Post Heat Treatments as Per Welding Procedurespecification andclient requirements.Dimensional control & NDT Inspections for all of the above products.Carrying out stage by stage Inspection as per the project specification for the equipments like Static &Rotator’s, NDT, Hydro testing, Internals Assembly, piping, Fireproofing, Insulating and Alsocoordinating with the THIRD PARTY for various activities as per the supplied by the client from Thearrival, storage yard, preservation, protection, erection and commissioning as per the Project specification.Coordination that all the inspection activities are documented as per the approved ITP.Coordination with the construction personals, Preparation of Quality Plan, Preparation Inspection Test Plans, Preparation Inspection Reports TRAININGS ATTENDED  Basic Survival Course (Abu Dhabi & Iran Kish safety training Institute)  Basis Fire fighting and Rescue operation course in Abu Dhabi& Iran Kish safety training Institute  Basic Fire Fighting/BA apparatus training by Abu Dhabi& Iran Kish safety training Institute.  Basic First Aid and Emergency ResponseAbu Dhabi& Iran Kish safety training Institute.  Helicopter Under water Crash Evacuation.  Training in Critical Life Activities – Lifting Awareness, Confined Space entry, Lock out/Tag out, Electrical Safety, Mechanical Lifting, NDE examination, Permit to Work. SOFTWARE SKILLS  Diploma in AUTOCADD, Microsoft Office – 2007, Windows 8.1 SKILLS & COMPETENCIES  Basic Personnel Management Skills, Basic financial budget analysis, Broad engineering experience, Good communications skills, Good presentation skills, Ability to forecast and analyze, Able to work under pressure, Able to manage time and resources efficiently, Able to delegate appropriately, Able to contribute to staff development, Excellent Coordination, Monitoring and Supervisory skills, Problem solving skills under dead- lines and Pressure., Team work coordination and leadership skills., Extensive knowledge of codes and standards in EPCM Projects., Thorough knowledge of Safety and Quality Procedures.
