USAR COORDINATION CELL (UCC)
ANUP SINGH,DC
NDRF ACADEMY,NAGPUR

USAR COORDINATION STRUCTURE
Once UNDAC arrives and establishes the OSOCC the UCC moves into the
OSOCC.
UCC transition into the OSOCC
Establish UCC
Arrival
Establish
OSOCC
UCC
briefing
to
UNDAC
UCC becomes part
of OSOCC
UCC
USAR TEAMS
UNDAC
Arrival
EXPECTATIONS - USAR TEAMS
Establish and/or support USAR coordination functions:
 Sector Coordination Cell (SCC)
 Reception Departure Centre (RDC)
 USAR Coordination Cell (UCC)
Expectations - USAR teams

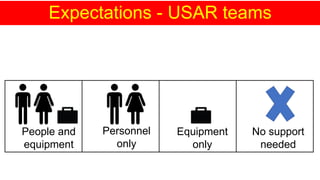

People and
equipment
Personnel
only
Equipment
only
No support
needed
Where does UCC ‘fit in’?
UCC

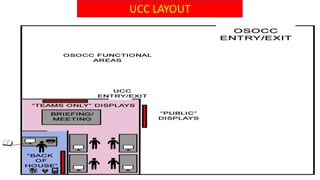

UCC LAYOUT
UCC Functions
UCC
MANAGER
UCC
PLANNING
UCC
LOGISTICS
UCC INFO
MANAGEMENT
All work is collaborative
The staffing allocation is scalable.
Manager
• Responsible for overall cell operation
• Final decision making
• Responsible for reports up and briefs dow
Planning
• Analyses information
• Formulates upcoming Plan of
Action
Information Management
• Processes information
• Generates data products
• Virtual OSOCC
Logistics
• Coordinates supply and resupply
for the assigned resources
• Takes care of UCC logistics needs
UCC staff will fill multiple positions until
the arrival of support from other teams.
Information displays for team managers and OSOCC personnel
Standardised information display forms can be downloaded from www.insarag.org- http://www.insarag.org/methodology/ucc
1. “Public” displays should include:
2. “Team Only” displays should include:
3. “UCC Staff Only” displays should include:

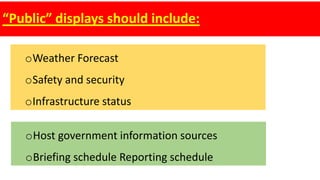

“Public” displays should include:
oWeather Forecast
oSafety and security
oInfrastructure status
oHost government information sources
oBriefing schedule Reporting schedule
oKey contacts & locations
oHumanitarian impact
oVictim handling guidelines UCC organogram
oAirport information

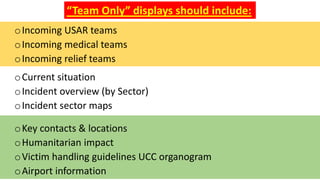

“Team Only” displays should include:
oIncoming USAR teams
oIncoming medical teams
oIncoming relief teams
oCurrent situation
oIncident overview (by Sector)
oIncident sector maps

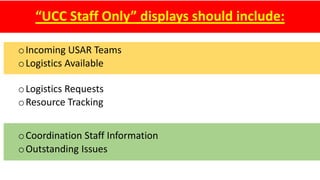

“UCC Staff Only” displays should include:
oCoordination Staff Information
oOutstanding Issues
oIncoming USAR Teams
oLogistics Available
oLogistics Requests
oResource Tracking
Team Fact Sheet
Worksite Triage Form
Worksite Report Form
Victim Extrication Form
Demobilisation Form
Team Tools
Team Fact Sheet Summary
USAR Operations Management Tool
Incident/Sector Situation Report
Coordination Tools
Sector coordination – when to activate
• When the coordination structure is operating at or beyond
maximum capacity
• If span of coordination is expected to exceed 7
• If the incident is spread across a wide area
• If Sub-OSOCC’s have been established
• At the earliest appropriate time

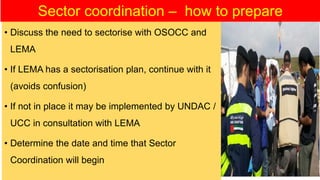

Sector coordination should be activated:
• Discuss the need to sectorise with OSOCC and
LEMA
• If LEMA has a sectorisation plan, continue with it
(avoids confusion)
• If not in place it may be implemented by UNDAC /
UCC in consultation with LEMA
• Determine the date and time that Sector
Coordination will begin
Sector coordination – how to prepare
UCC
A
B
C
OSOCC
RDC
SC
SC
SC
USAR
TEAM
Sector coordination
UCC
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
T
E
A
M
Sector
Coordinator
Sector
Coordinator
Sector
Coordinator

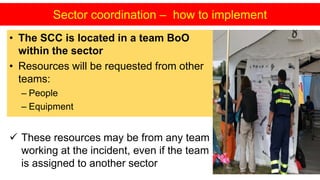

• The SCC is located in a team BoO
within the sector
• Resources will be requested from other
teams:
– People
– Equipment
Sector coordination – how to implement
 These resources may be from any team
working at the incident, even if the team
is assigned to another sector

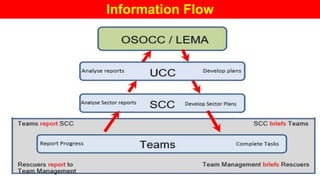

Information Flow
Allocating resources

Decisions should always be documented.
Assignments should always be tasked in writing.
Allocating resources

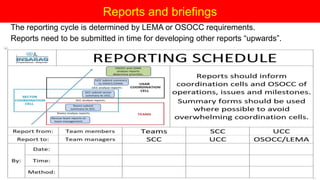

The reporting cycle is determined by LEMA or OSOCC requirements.
Reports need to be submitted in time for developing other reports “upwards”.

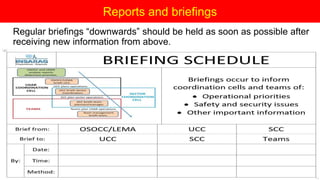

Reports and briefings
Regular briefings “downwards” should be held as soon as possible after
receiving new information from above.
Reports and briefings

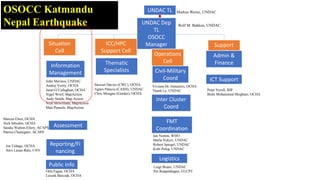

UNDAC TL
UNDAC Dep
TL
OSOCC
ManagerSituation
Cell
Assessment
Information
Management
Support
CellOperations
Cell
ICC/HPC
Support Cell
Reporting/Fi
nancing
Public Info
Markus Werne, UNDACOSOCC Katmandu
Nepal Earthquake
John Marinos, UNDAC
Andrej Verity, OCHA
Janet O’Callaghan, OCHA
Nigel Woof, MapAction
Andy Smith, Map Action
Nick Mcwilliam, MapAction
Matt Pennels, MapAction
Admin &
Finance
ICT Support
Peter Nyrell, IHP
Bishr Mohammed Mirghani, OCHA
Marcus Elten, OCHA
Nick Inboden, OCHA
Sandie Walton-Ellery, ACAPS
Patrice Chataigner, ACAPS
Joe Tobago, OCHA
Alex Lazau-Ratz, UNV
Orla Fagan, OCHA
Leszek Barczak, OCHA
Inter Cluster
Coord
FMT
Coordination
Civil-Military
Coord
Logistics
Thematic
Specialists
Stewart Davies (CWC), OCHA
Agnes Palacio (CASH), UNDAC
Chris Mougne (Gender), OCHA
Viviana De Annuntiis, OCHA
Thanh Le, UNDAC
Ian Norton, WHO
Marla Nykyri, UNDAC
Robert Spiegel, UNDAC
Kobi Peleg, UNDAC
Luigi Bruno, UNDAC
Per Reppenhagen, EUCPT
Rolf M. Bakken, UNDAC
RDC NEOC
Coordination
Hub
Gorkha
Coordinatio
n Hub
Chautara
Operations
Cell
UNDAC TL
UNDAC Dep
TL
OSOCC
Manager
Markus Werne, UNDAC
Rolf M. Bakken,
UNDAC
George Murray, UNDAC
Arjun Katoch, UNDAC
Ram Luetel, OCHA
Yosuke Okita, UNDAC
Tsukasa Katsube, UNDAC
Martin Liebl, EUCPT
USAR Coord
Cell
BoO
Samantha Orr, UNDAC
Albrecht Beck, UNDAC
Christian Di Schiena, UNDAC
Nihan Erdogan, UNDAC
Anders Öberg, EUCPT
Åke Johansson, IHP
Sven Olof Sjökvist, IHP
Andy Smith, MapAction
Hannes Goegele,
UNDAC
Bruno Ulliac, UNDAC
James Brown, UNDAC
Nenad Grkovic, UNDAC
Miroslav Lukes, EUCPT
Knut Kjørkleiv, IHP
Kirsty Ferris, MapAction
Winston Chang, UNDAC
Karl-Heinz Frank, UNDAC

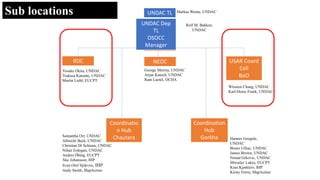

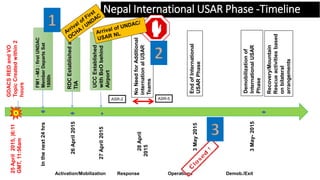

Sub locations
GDACSREDandVO
TopicCreatedwithin2
hours
25April2015,)6:11
GMT,11:56am
RDCEstablishedat
TIA
26April2015
Activation/Mobilization Response Operations Demob./Exit
NoNeedforAdditional
internationalUSAR
Teams
28April
2015
EndofInternational
USARPhase
3May2015
UCCEstablished
withBoObehind
Airport
27April2015
Nepal International USAR Phase -Timeline
FM1–M3:firstUNDAC
MemberDepartsSat
1800h
Inthenext24hrs
Demobilizationof
InternationalUSAR
Phase
3May-2015
Recovery/Mountain
Rescueactivitiesbased
onbilateral
arrangements
ASR-5ASR-2
USAR Coordination meetings - Nepal

Sector Coordination meetings - Nepal
Demobilisation
As the rescue phase winds down the UCC:
• Plans for closure
• Supports teams returning home (in coordination with the RDC)
When the OSOCC advises that the UCC is to be shut down,
coordination is handed over to the OSOCC.
Facilitates transition of USAR resources to other activities such as
“Beyond the rubble”
INSARAG documentation used during operations
 Sector/Incident summary
UCC  Operations Management Tool
 Team Fact Sheet summary
SCC
 Sector/incident summary (If SCC is not
 Operations Management Tool established)
Team
 Sector/incident summary
 (copies of documents below may be attached)
management 
 Demobilisation form
 Wide area assessment
Team
 Sector assessment
 Worksite triage
members  
 Worksite reports
 Victim extrication form
THANKS
