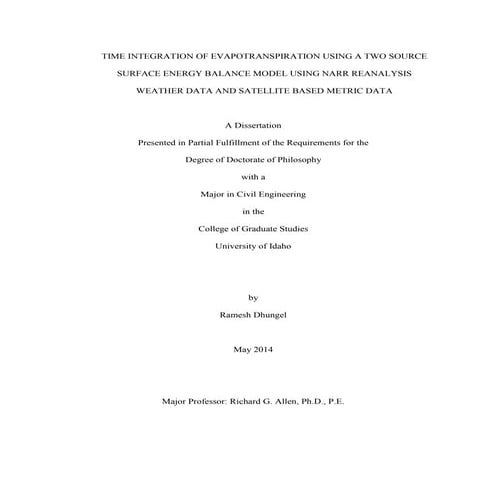

Time integration of evapotranspiration using a
two source surface energy balance model
using NARR reanalysis weather and satellite
based METRIC data
Ramesh Dhungel
Major professor: Dr. Richard G. Allen
Committee Members:
Dr. Fritz Fiedler, Dr. Karen Humes, Dr. Ricardo Trezza
Department of Civil Engineering
University of Idaho
Developed methodologies and models
Dissertation defense

Outline
 Background and Motivation
 Problem statement
 Objectives
 Results and discussions
 Methodology
 Study Area

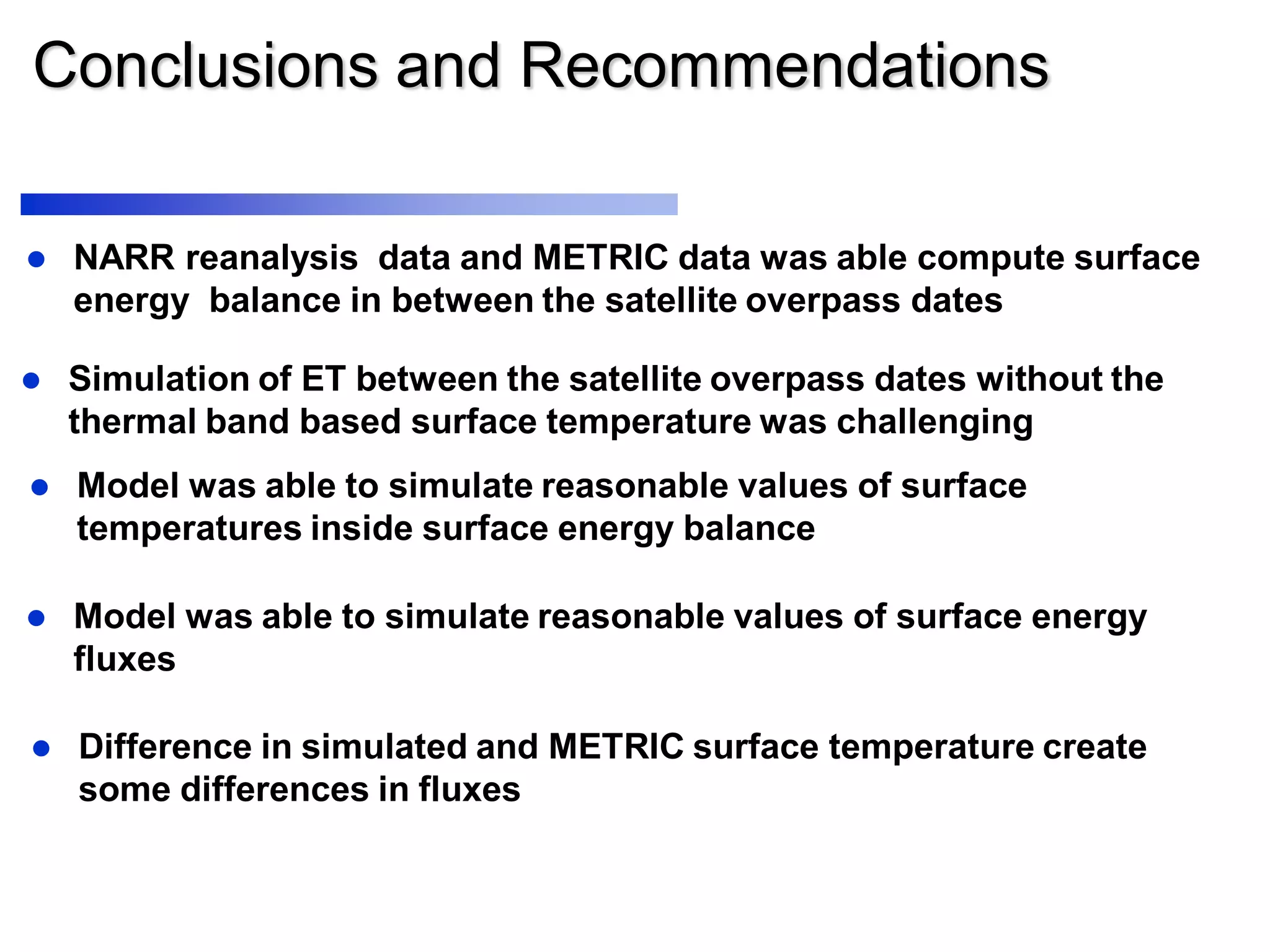

 Conclusions and Recommendations

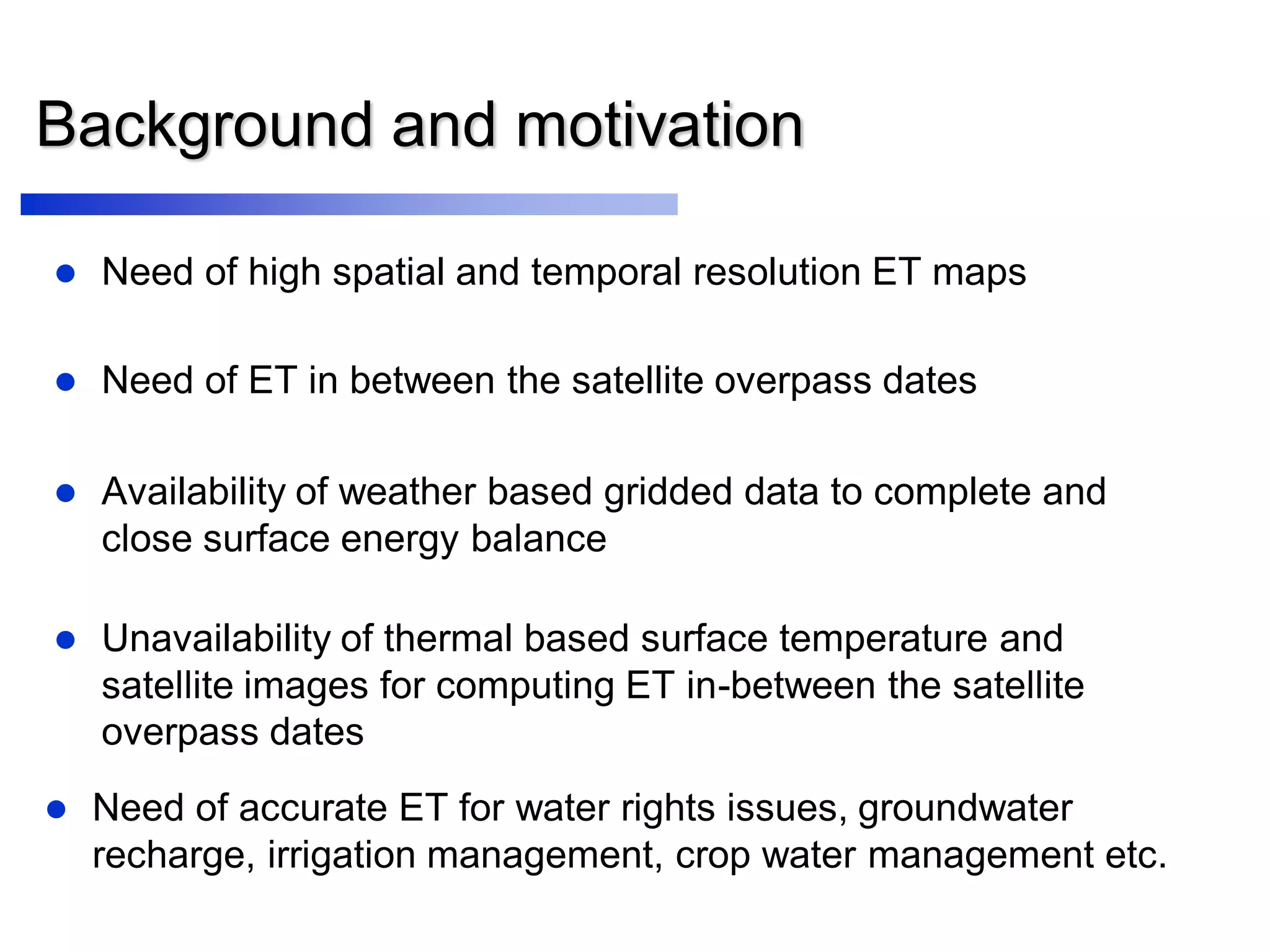

Background and motivation
 Need of high spatial and temporal resolution ET maps
 Availability of weather based gridded data to complete and
close surface energy balance
 Need of ET in between the satellite overpass dates
 Unavailability of thermal based surface temperature and
satellite images for computing ET in-between the satellite
overpass dates
 Need of accurate ET for water rights issues, groundwater
recharge, irrigation management, crop water management etc.

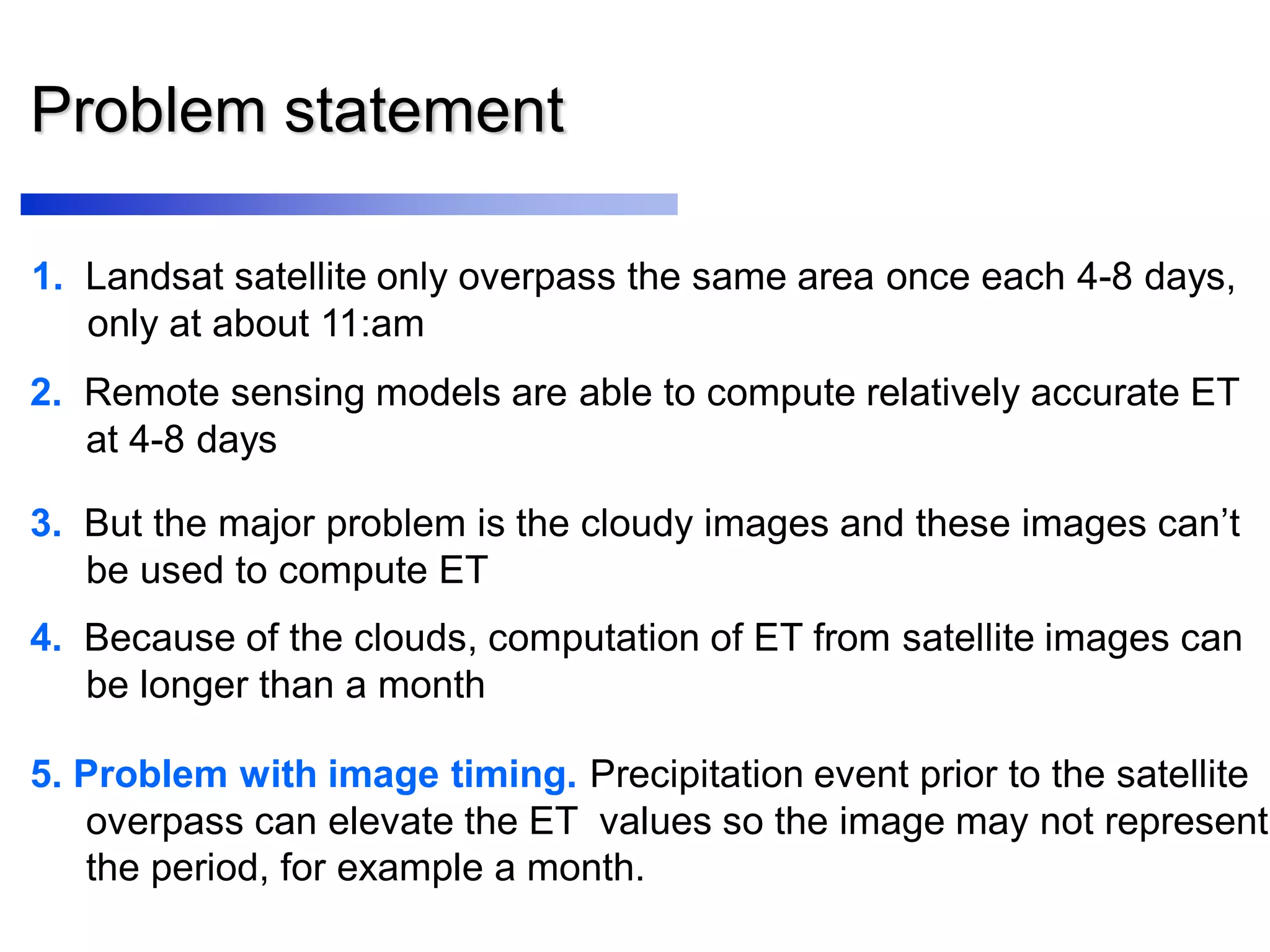

Problem statement
1. Landsat satellite only overpass the same area once each 4-8 days,
only at about 11:am
2. Remote sensing models are able to compute relatively accurate ET
at 4-8 days
5. Problem with image timing. Precipitation event prior to the satellite
overpass can elevate the ET values so the image may not represent
the period, for example a month.
3. But the major problem is the cloudy images and these images can’t
be used to compute ET
4. Because of the clouds, computation of ET from satellite images can
be longer than a month

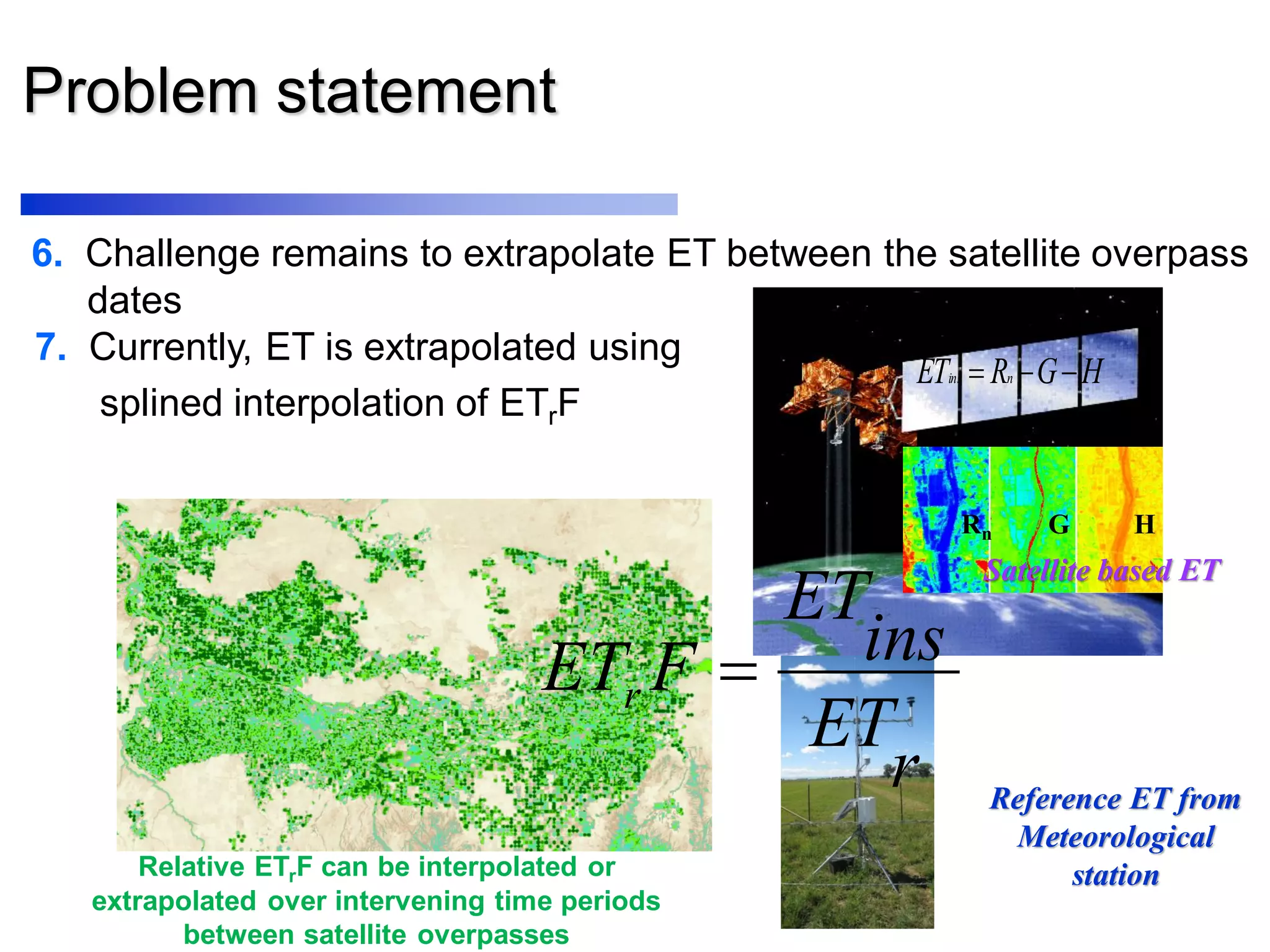

Problem statement
6. Challenge remains to extrapolate ET between the satellite overpass
dates
7. Currently, ET is extrapolated using
splined interpolation of ETrF
r
ET
ins
ET
FETr 
Reference ET from
Meteorological
station
HGRET nins 
Rn G H
Satellite based ET
Relative ETrF can be interpolated or
extrapolated over intervening time periods
between satellite overpasses

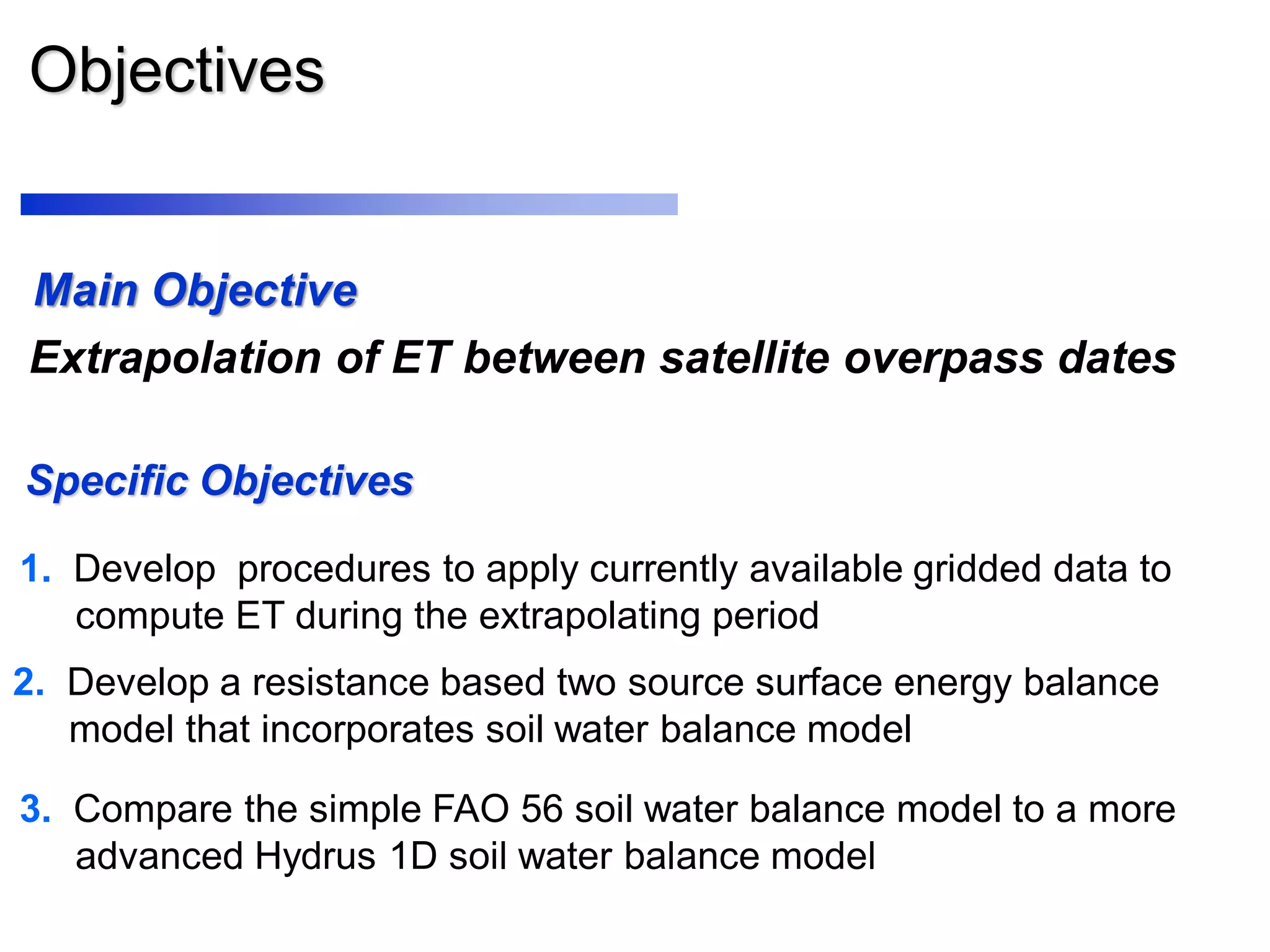

Objectives
Specific Objectives
1. Develop procedures to apply currently available gridded data to
compute ET during the extrapolating period

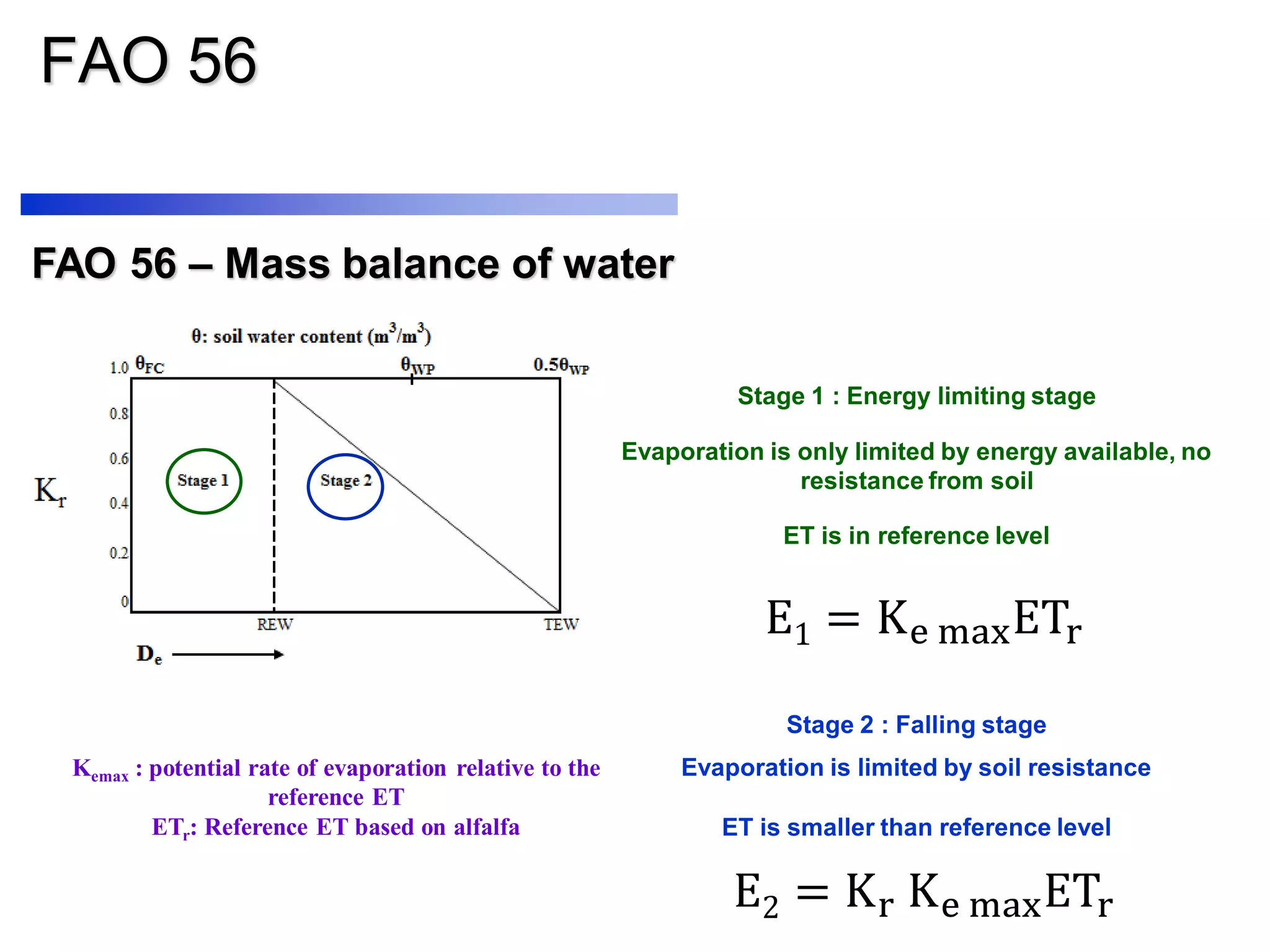

3. Compare the simple FAO 56 soil water balance model to a more
advanced Hydrus 1D soil water balance model
2. Develop a resistance based two source surface energy balance
model that incorporates soil water balance model
Extrapolation of ET between satellite overpass dates
Main Objective

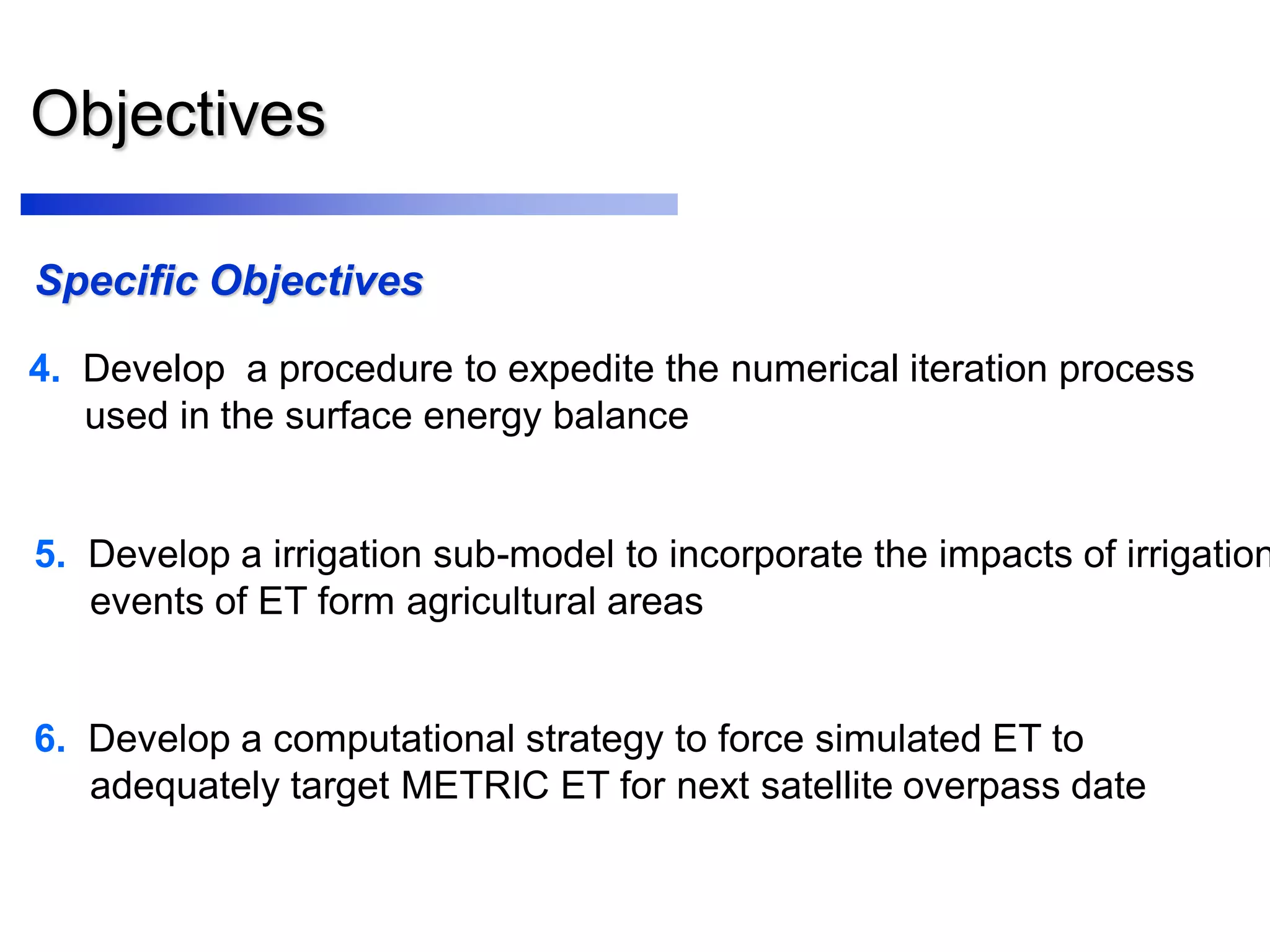

Objectives
Specific Objectives
4. Develop a procedure to expedite the numerical iteration process
used in the surface energy balance
6. Develop a computational strategy to force simulated ET to
adequately target METRIC ET for next satellite overpass date
5. Develop a irrigation sub-model to incorporate the impacts of irrigation
events of ET form agricultural areas
Methodology

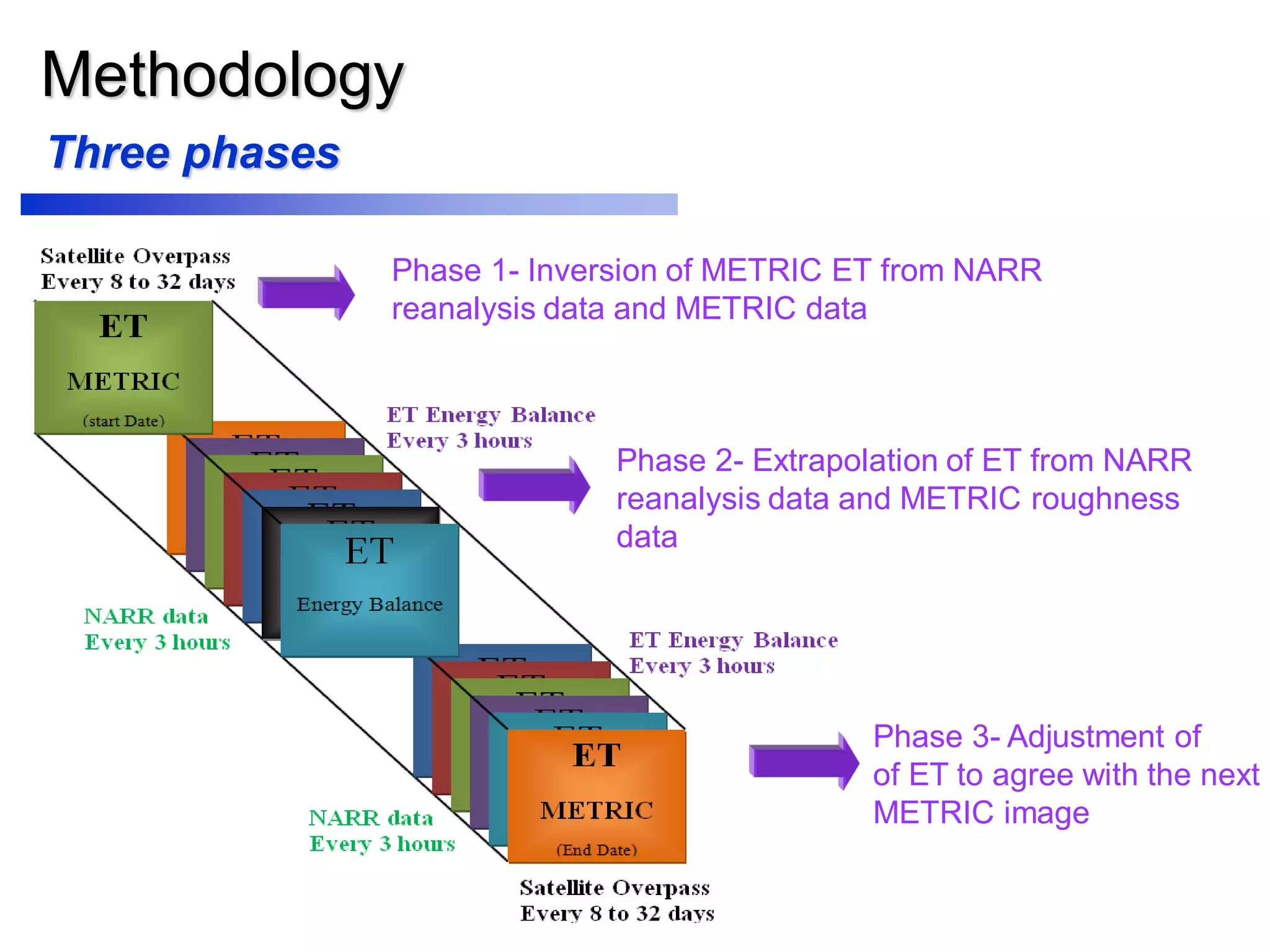

Three phases

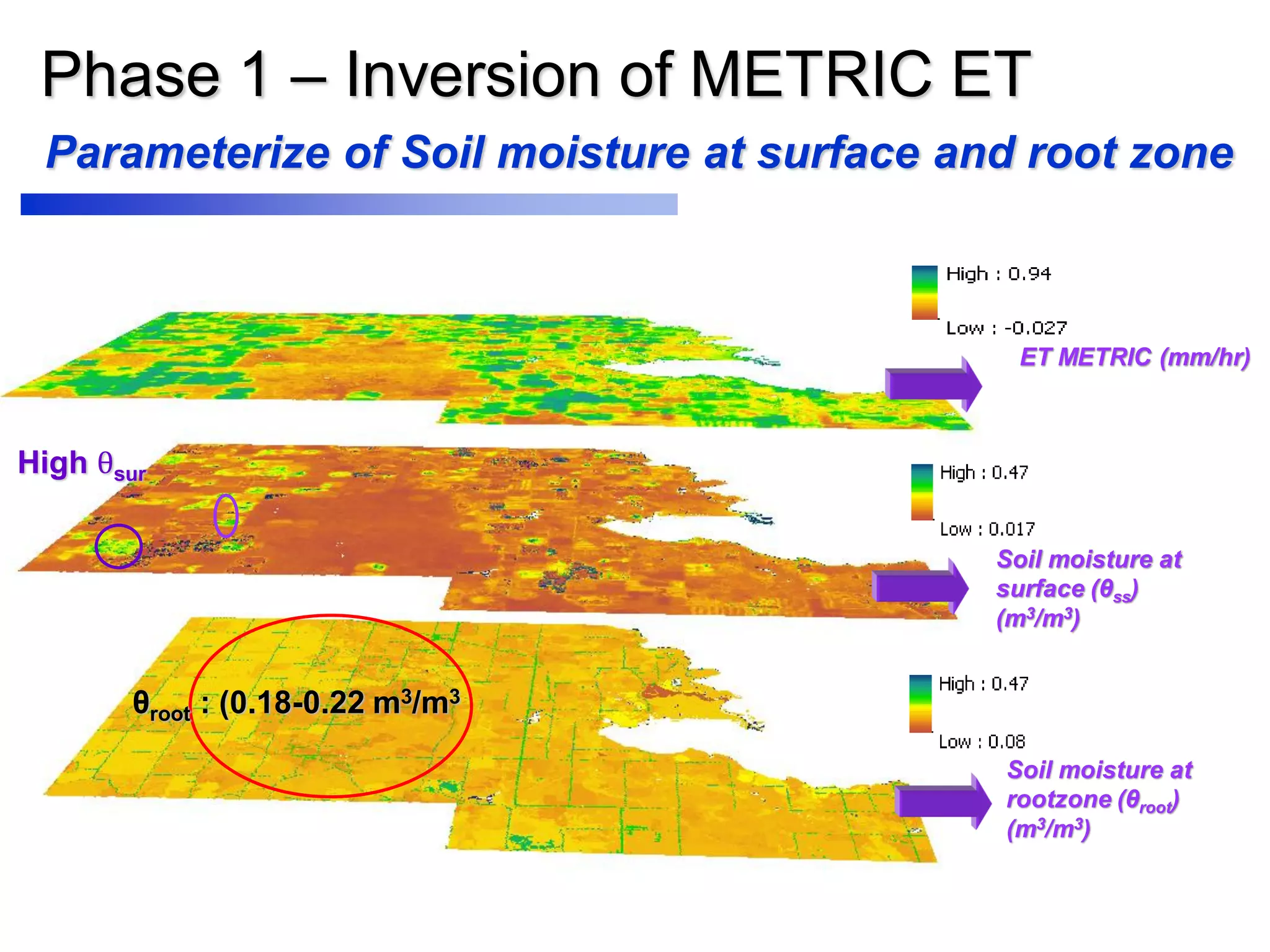

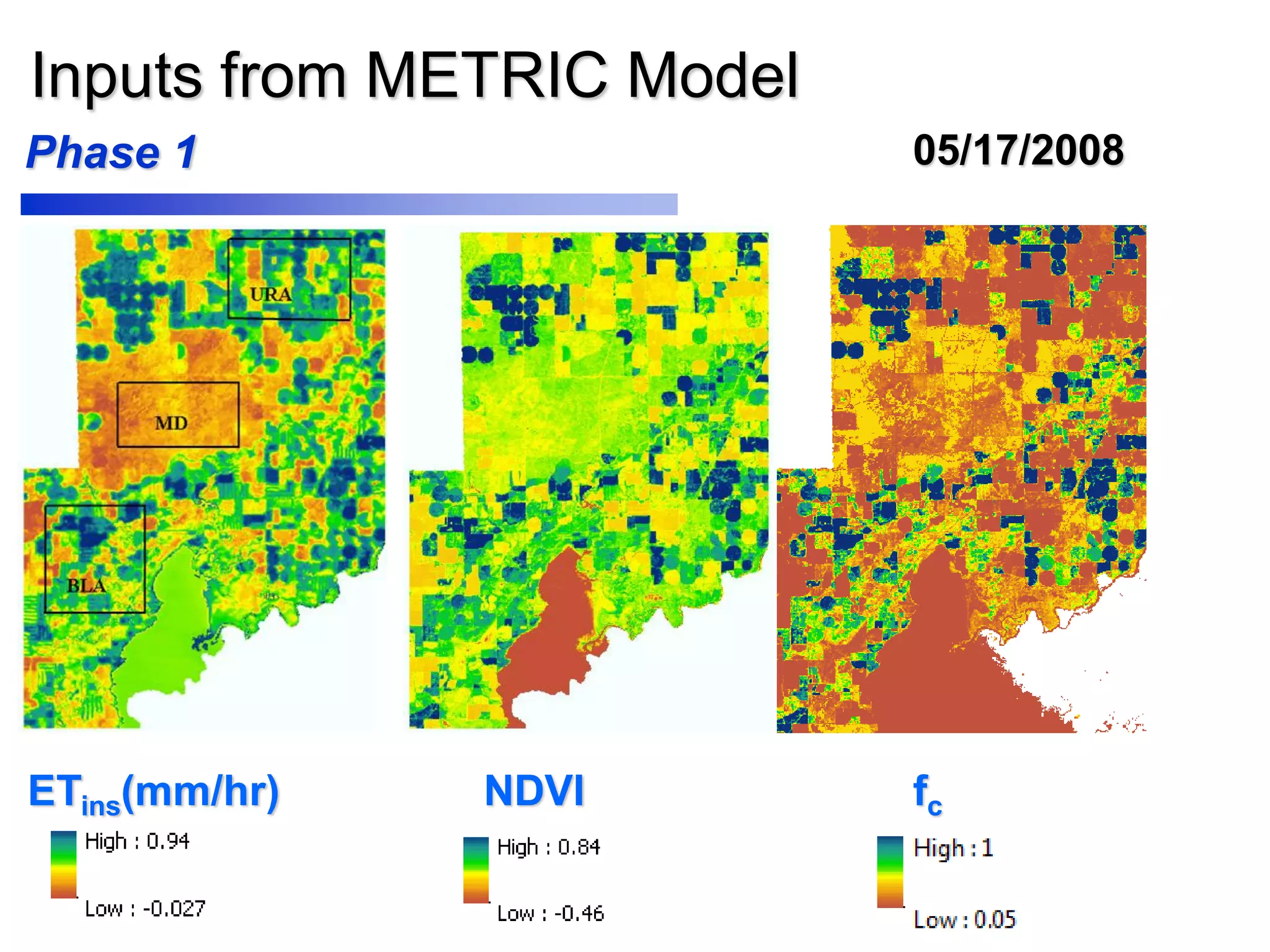

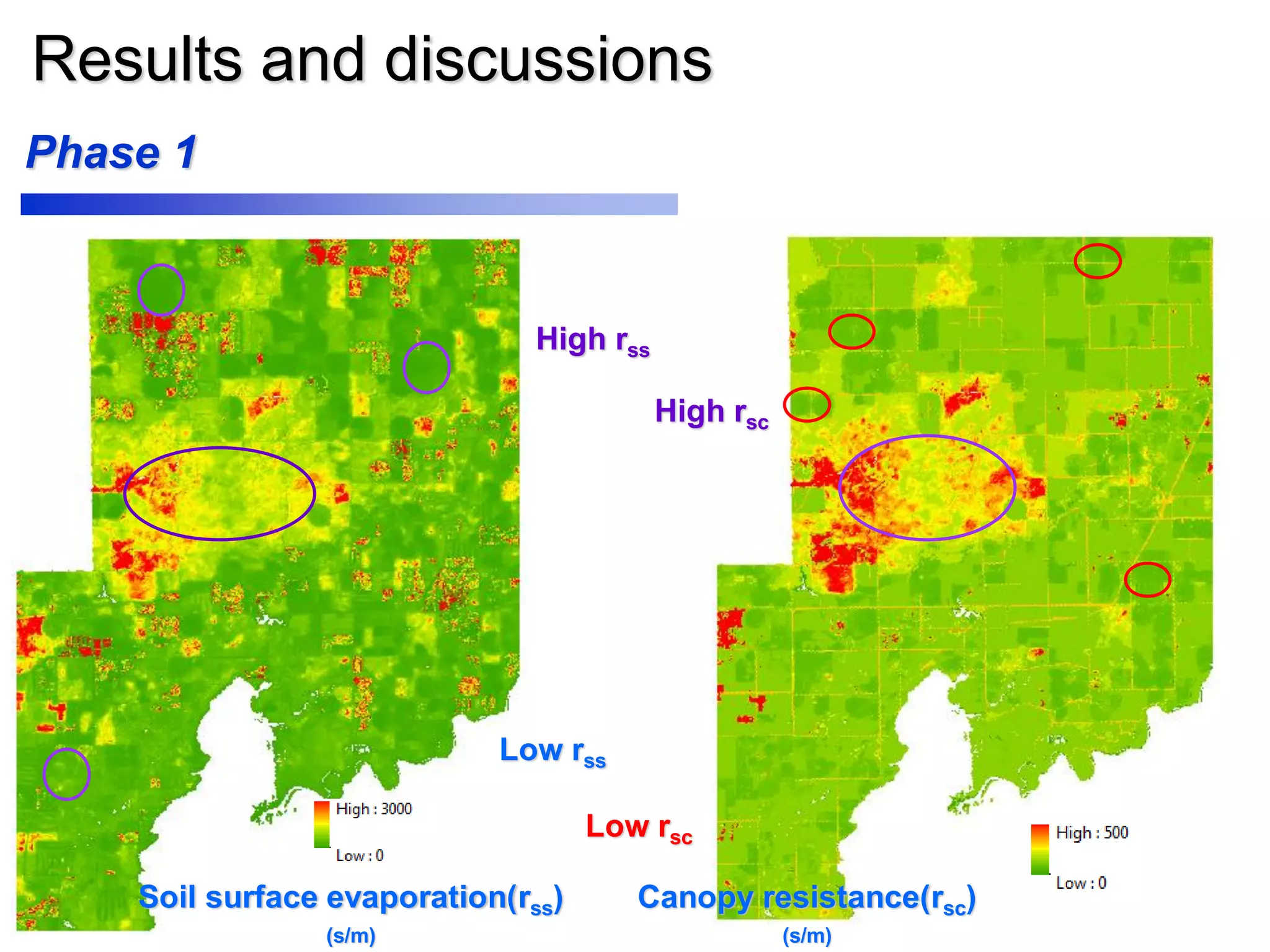

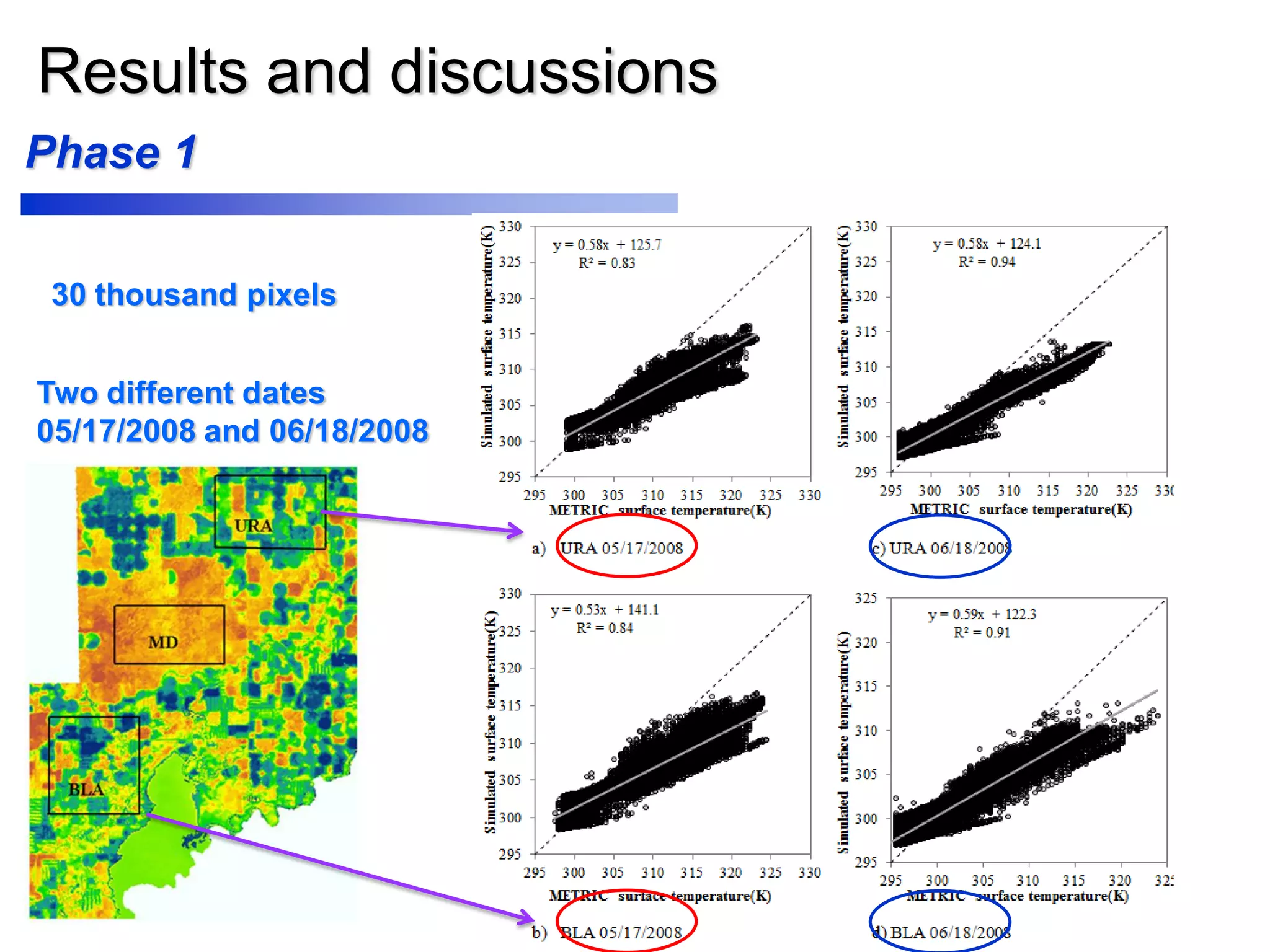

Phase 1- Inversion of METRIC ET from NARR
reanalysis data and METRIC data

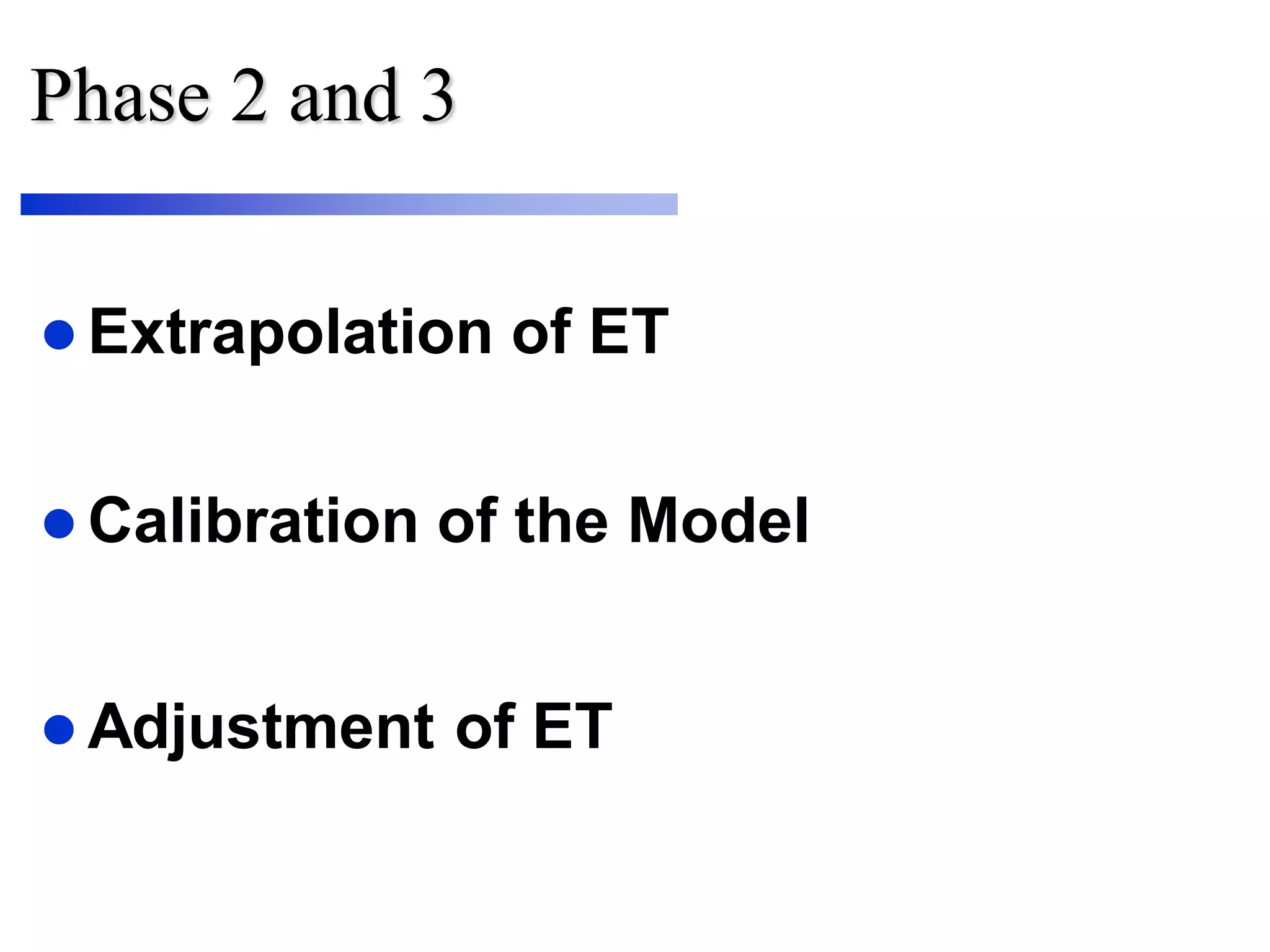

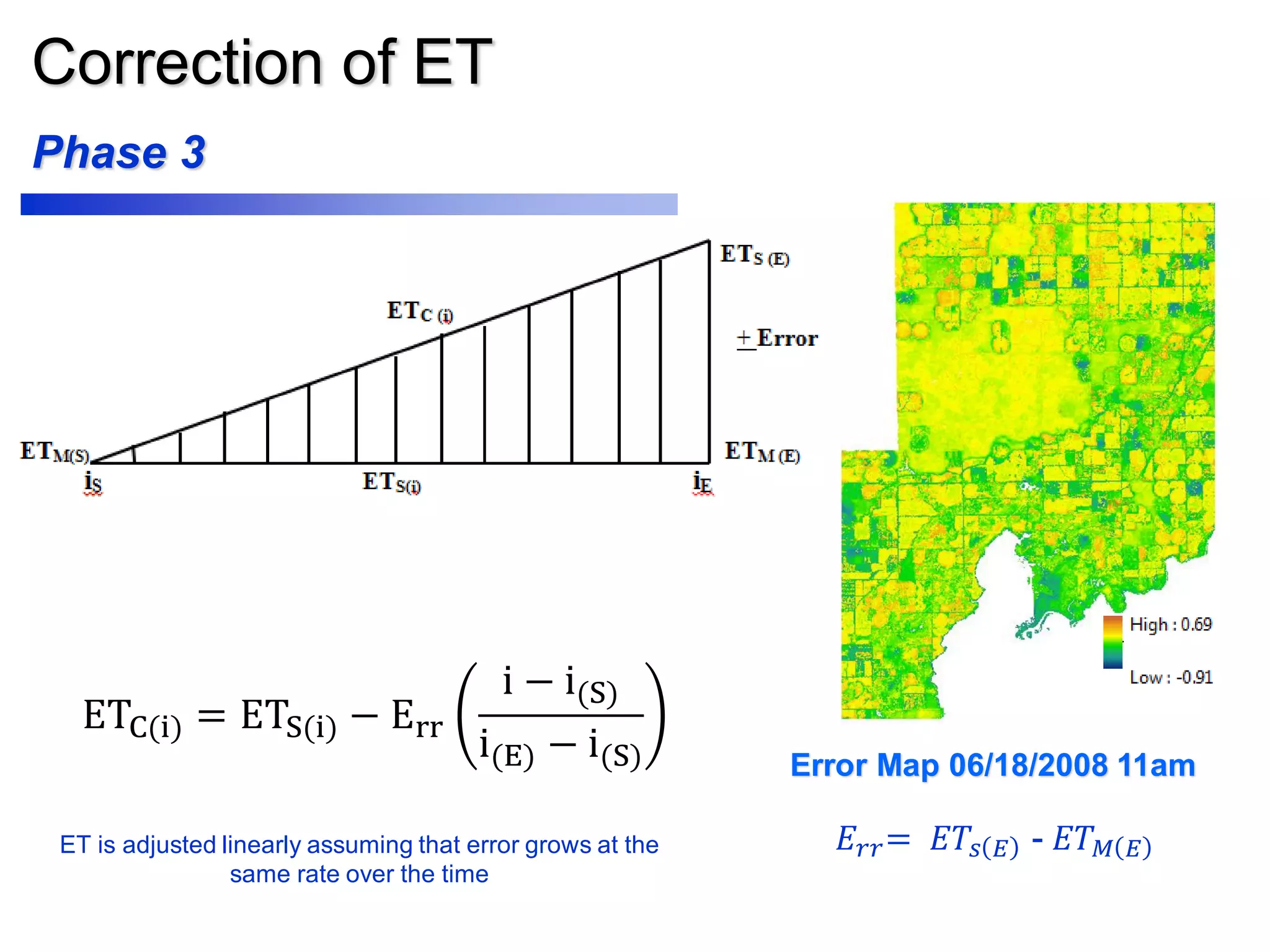

Phase 3- Adjustment of
of ET to agree with the next
METRIC image
Phase 2- Extrapolation of ET from NARR
reanalysis data and METRIC roughness
data

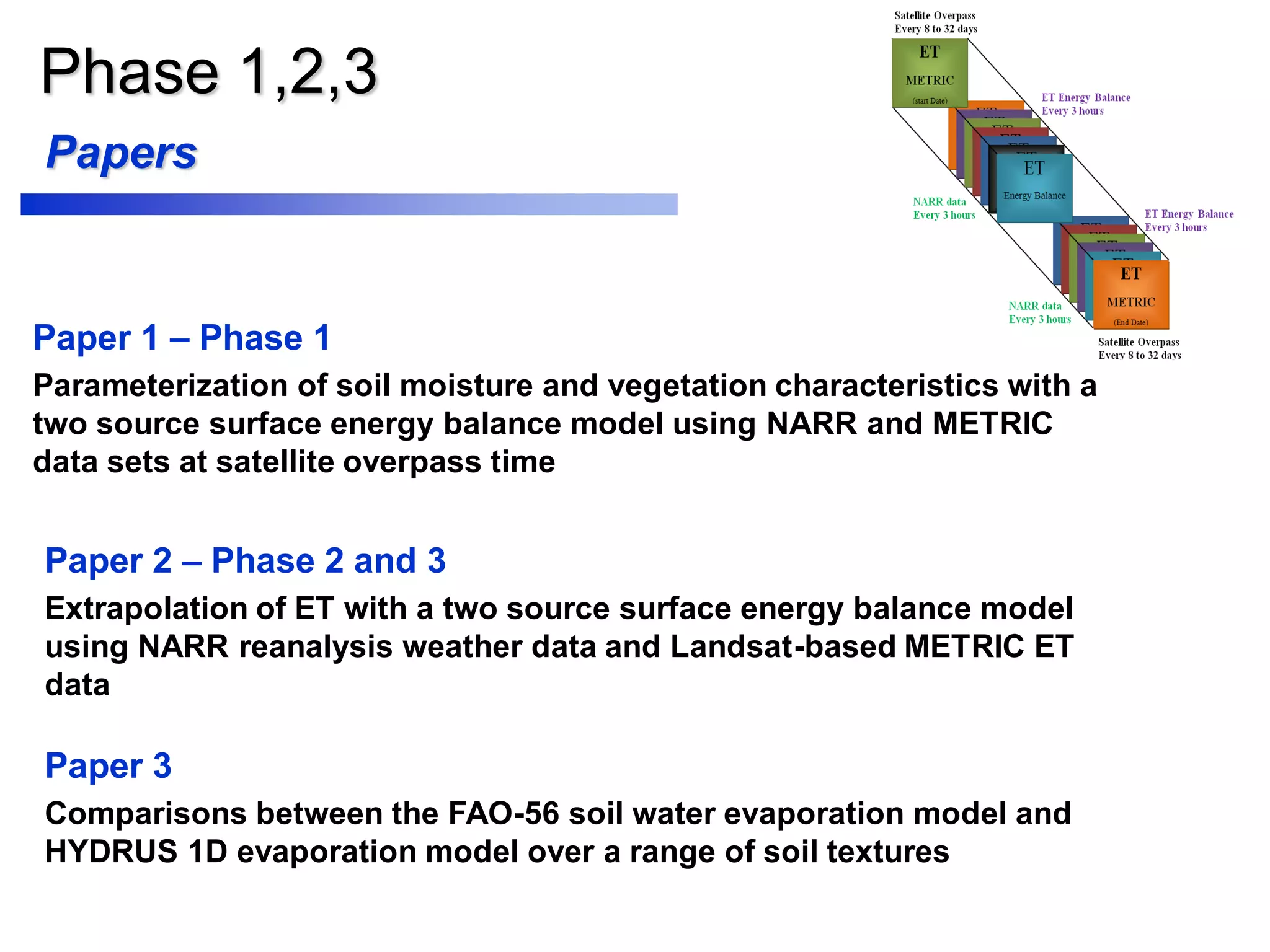

Phase 1,2,3
Papers

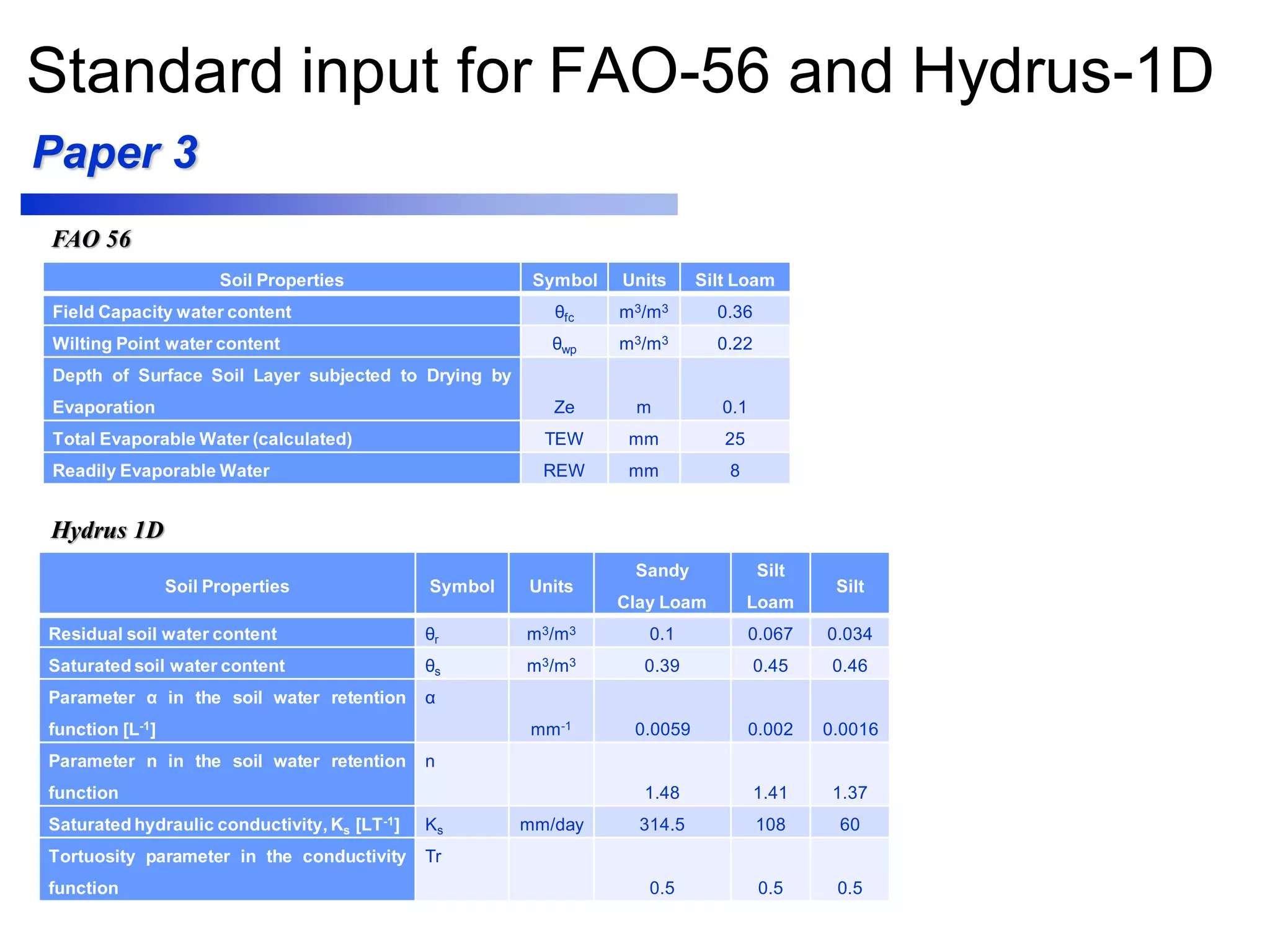

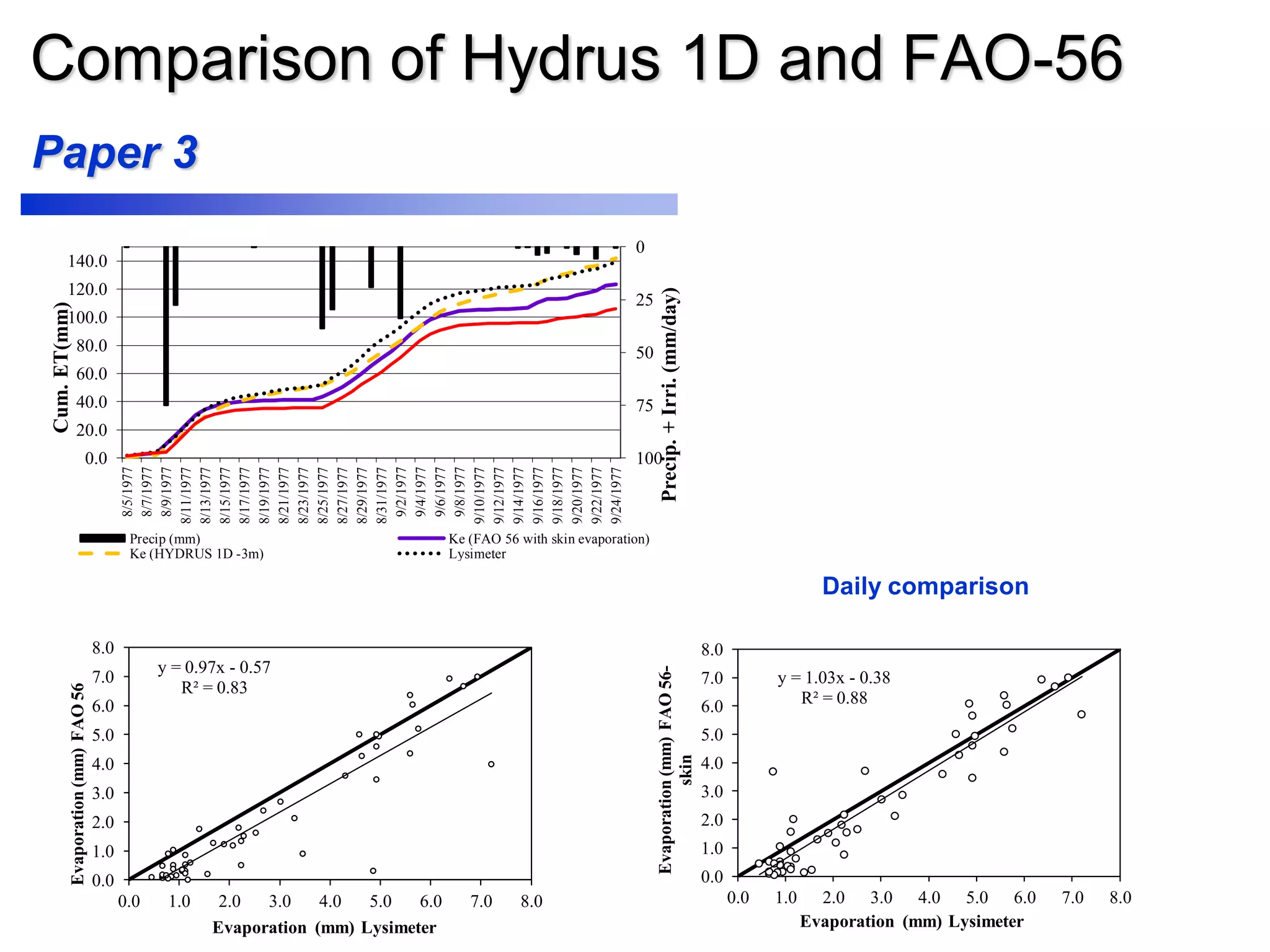

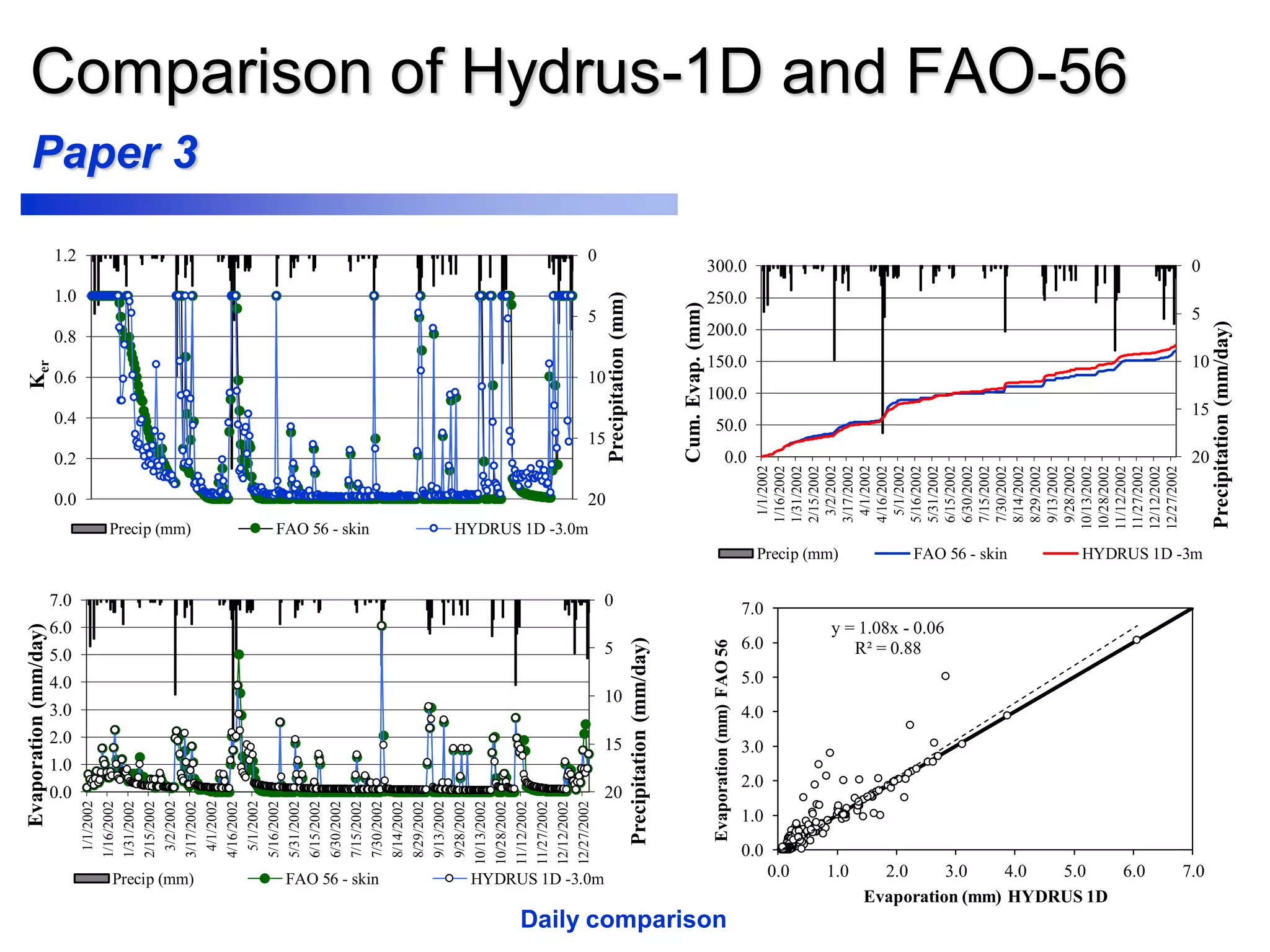

Paper 3

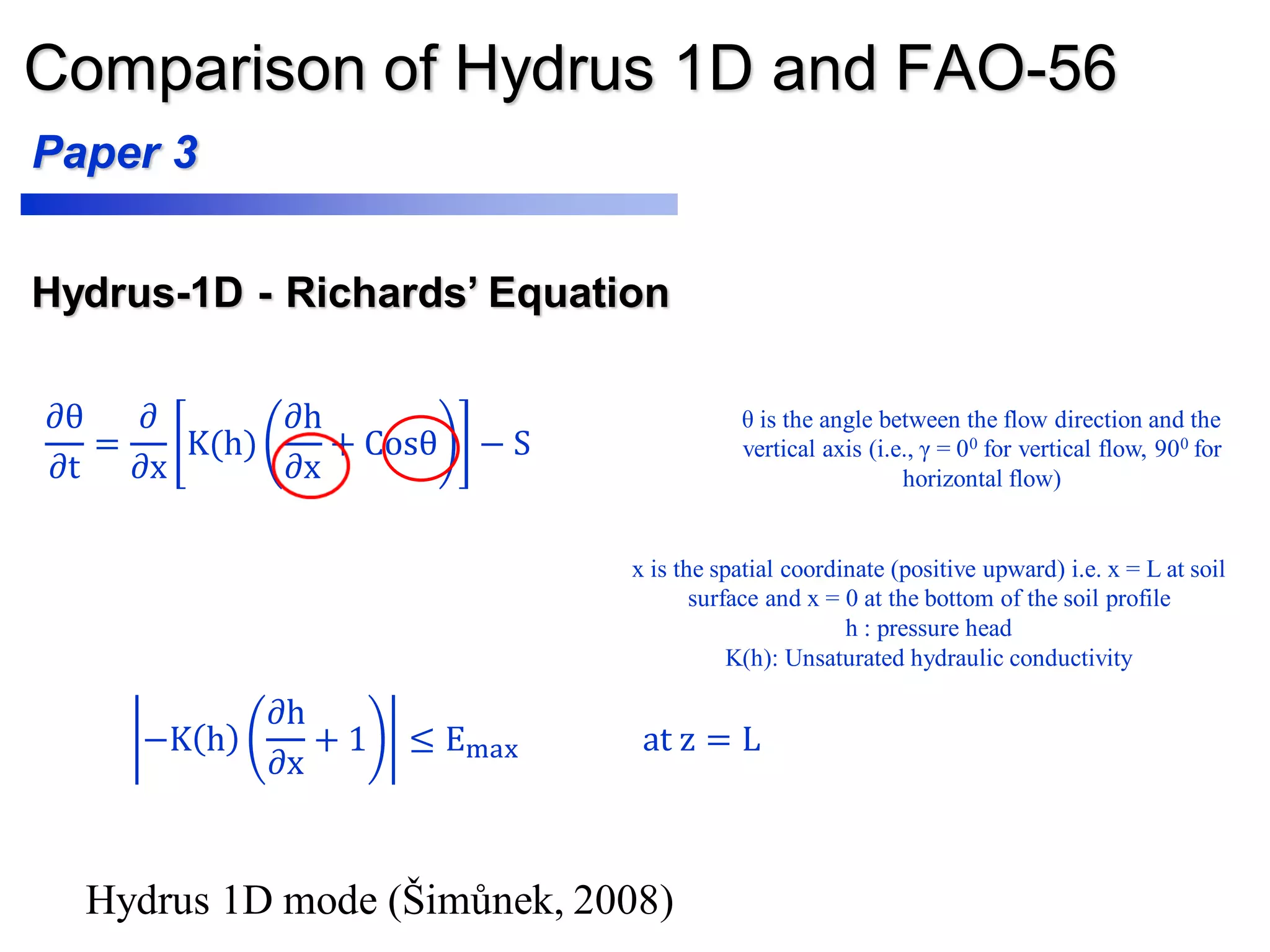

Comparisons between the FAO-56 soil water evaporation model and
HYDRUS 1D evaporation model over a range of soil textures
Paper 1 – Phase 1
Parameterization of soil moisture and vegetation characteristics with a
two source surface energy balance model using NARR and METRIC
data sets at satellite overpass time
Paper 2 – Phase 2 and 3
Extrapolation of ET with a two source surface energy balance model
using NARR reanalysis weather data and Landsat-based METRIC ET
data

Completion of study
 Literature Review
 Exploration of current available ET models and procedures (Single and multiple
sources)
– SEBAL (Bastiaanssen et al., 1998)
– SEBS (Su, 2002)
– ALEXI (Norman et al., 2003)
– METRIC (Allen et al., 2007)
– Raupach, 1989
– McNaughton and Van den Hurk, 1995
– Shuttleworth and Wallace, 1985
– Choudhury and Monteith, 1988
– Norman et al., 1995
– Li et al. 2005
– Colaizzi et al., 2012 etc.
 Development of a land surface model
 Testing the model
 Development of code

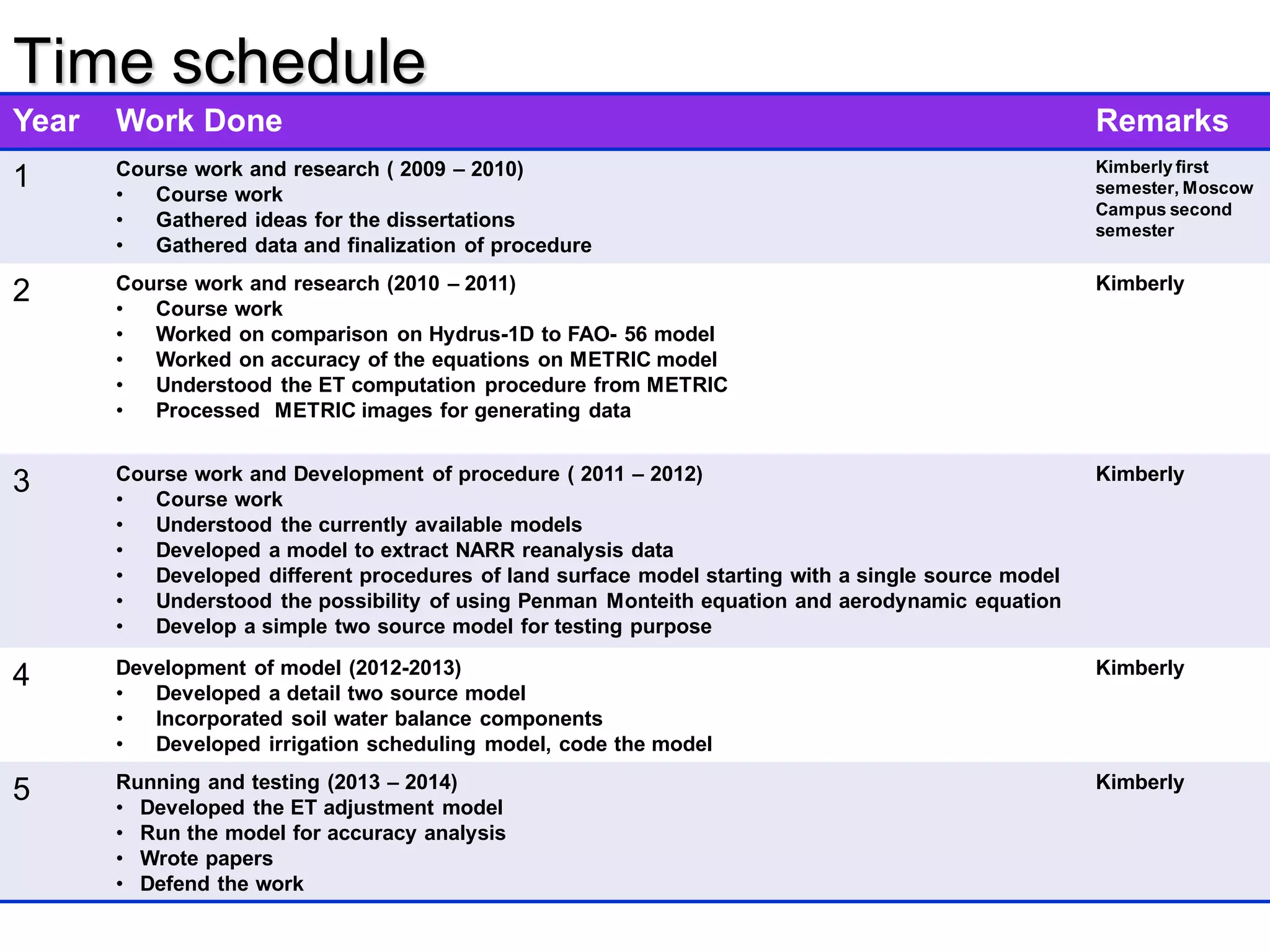

Time schedule
Year Work Done Remarks
1 Course work and research ( 2009 – 2010)
• Course work
• Gathered ideas for the dissertations
• Gathered data and finalization of procedure
Kimberly first
semester, Moscow
Campus second
semester
2 Course work and research (2010 – 2011)
• Course work
• Worked on comparison on Hydrus-1D to FAO- 56 model
• Worked on accuracy of the equations on METRIC model
• Understood the ET computation procedure from METRIC
• Processed METRIC images for generating data
Kimberly
3 Course work and Development of procedure ( 2011 – 2012)
• Course work
• Understood the currently available models
• Developed a model to extract NARR reanalysis data
• Developed different procedures of land surface model starting with a single source model
• Understood the possibility of using Penman Monteith equation and aerodynamic equation
• Develop a simple two source model for testing purpose
Kimberly
4 Development of model (2012-2013)
• Developed a detail two source model
• Incorporated soil water balance components
• Developed irrigation scheduling model, code the model
Kimberly
5 Running and testing (2013 – 2014)
• Developed the ET adjustment model
• Run the model for accuracy analysis
• Wrote papers
• Defend the work
Kimberly

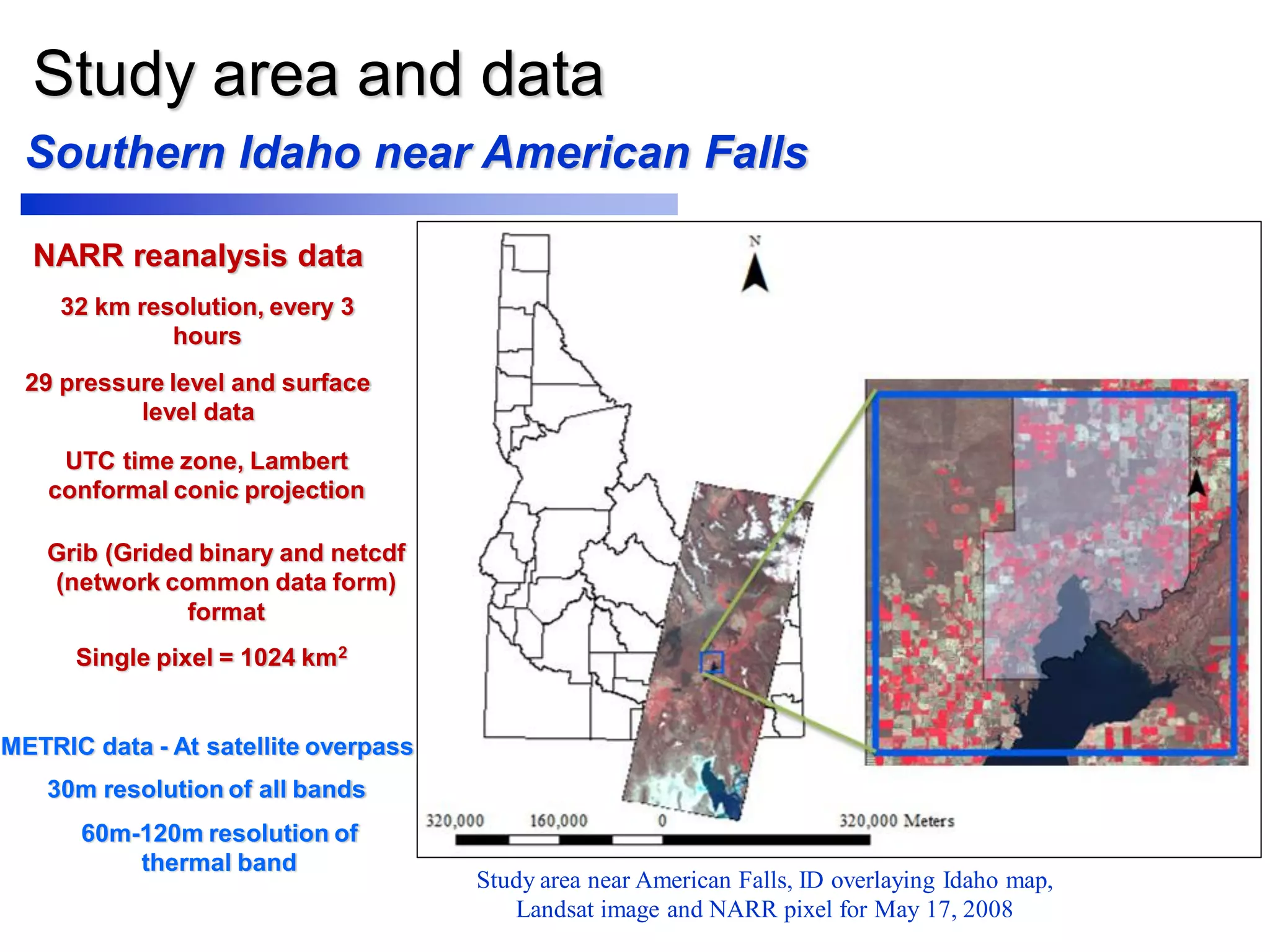

Study area and data
NARR reanalysis data
METRIC data - At satellite overpass
Single pixel = 1024 km2
32 km resolution, every 3
hours
29 pressure level and surface
level data
UTC time zone, Lambert
conformal conic projection
Grib (Grided binary and netcdf
(network common data form)
format
Southern Idaho near American Falls
Study area near American Falls, ID overlaying Idaho map,
Landsat image and NARR pixel for May 17, 2008
30m resolution of all bands
60m-120m resolution of
thermal band

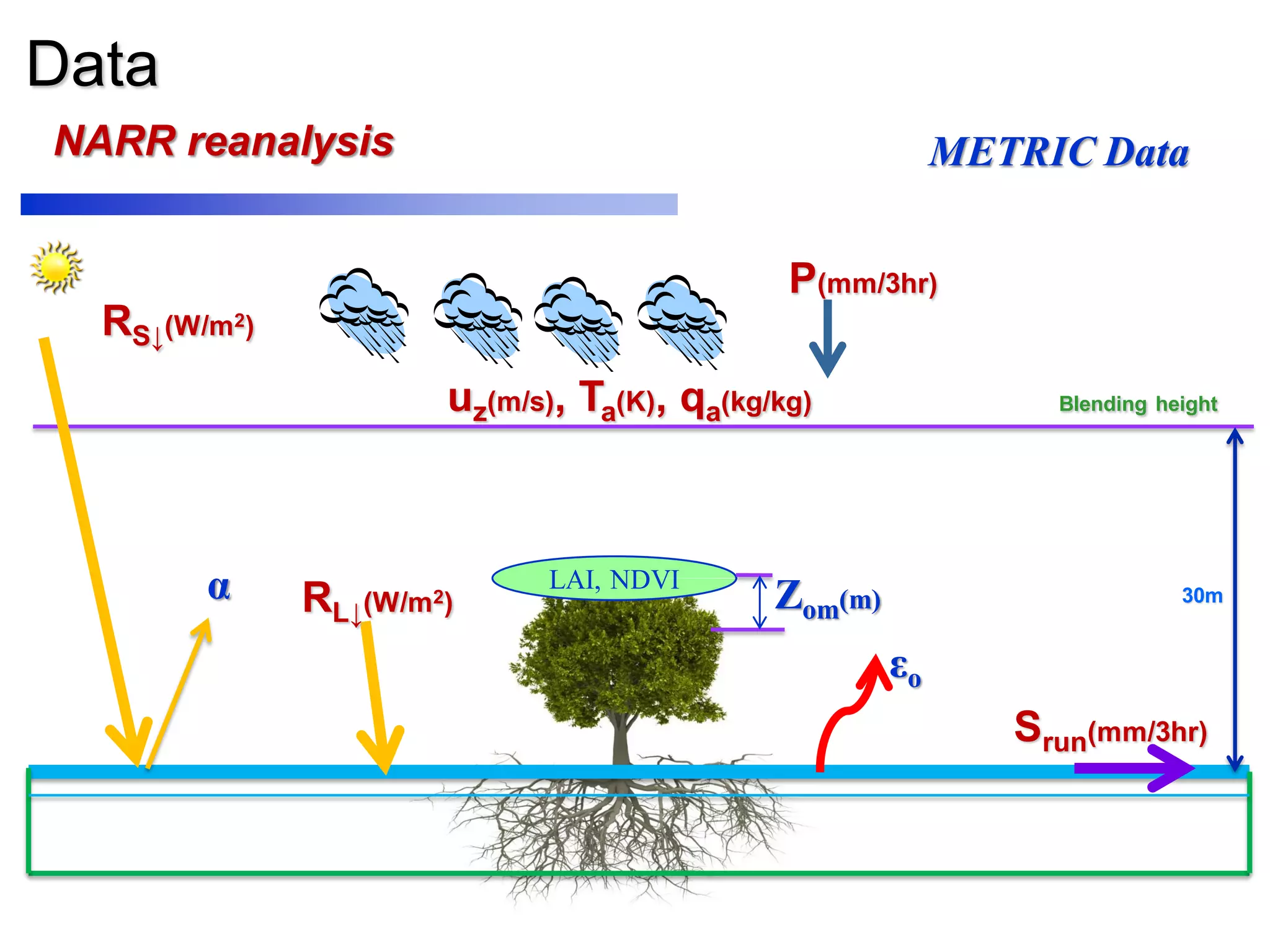

Data
uz(m/s), Ta(K), qa(kg/kg) Blending height
30m
RS↓(W/m2)
RL↓(W/m2)
P(mm/3hr)
Srun(mm/3hr)
α LAI, NDVI
εo
Zom(m)
NARR reanalysis METRIC Data

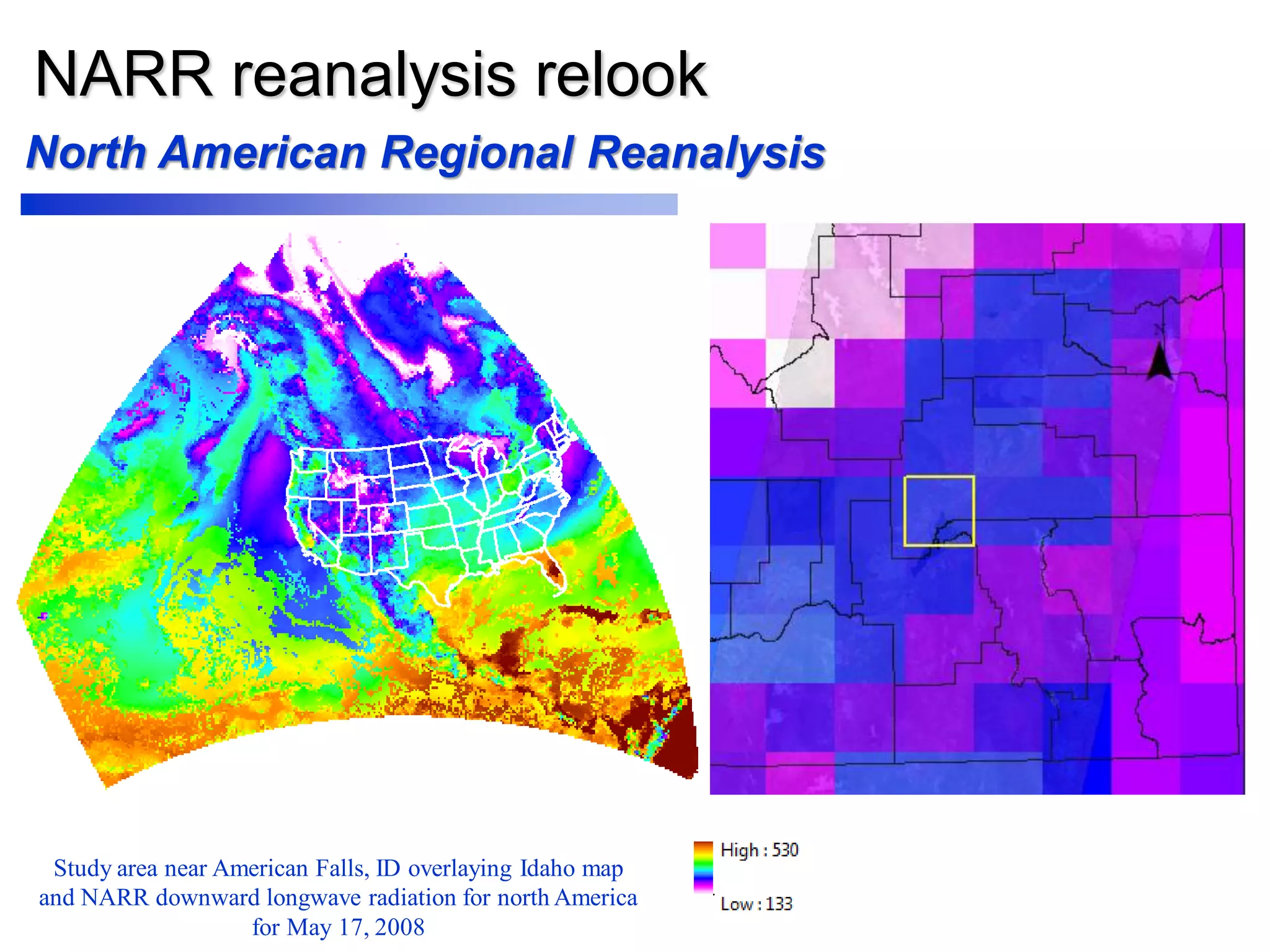

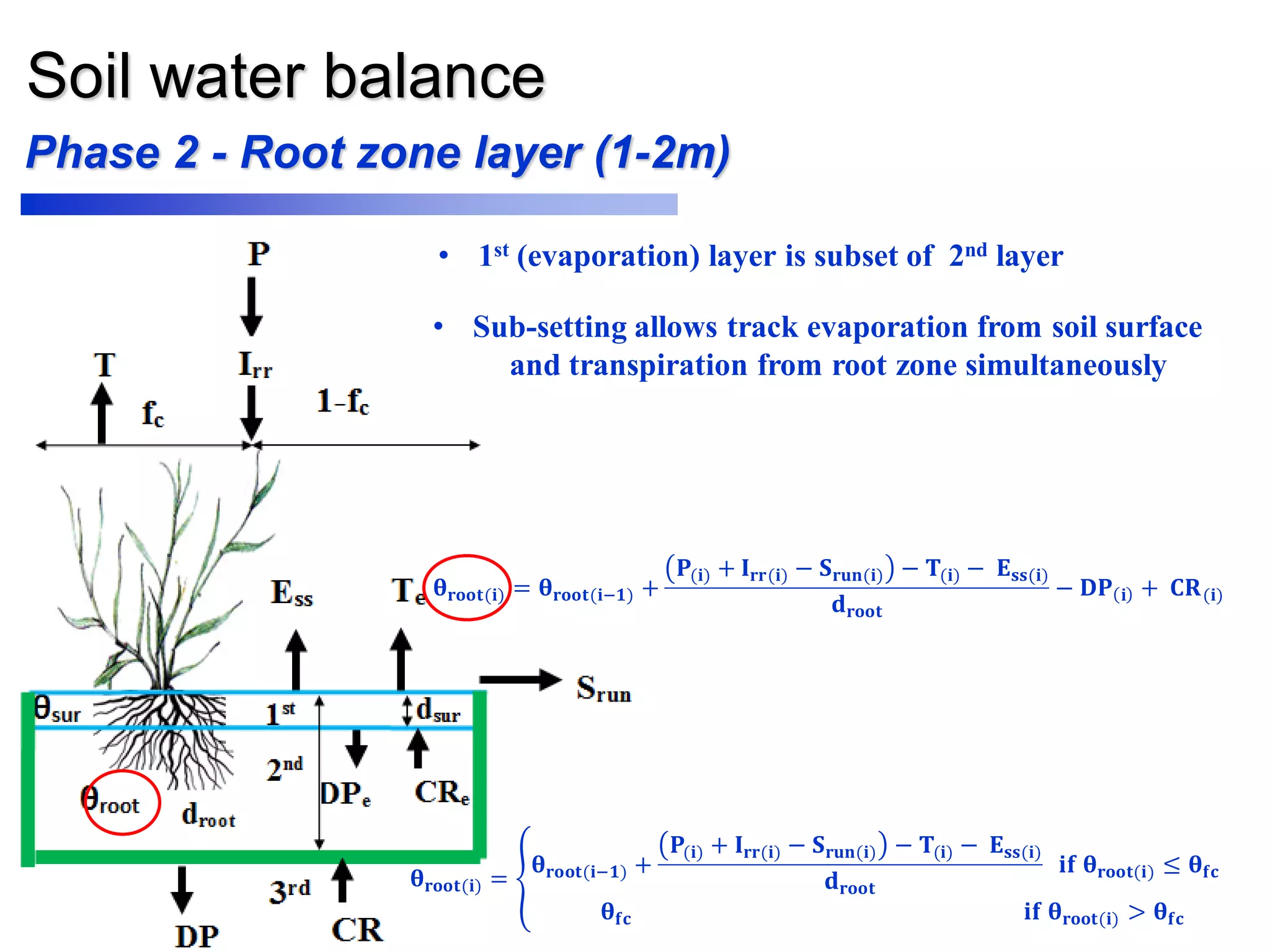

NARR reanalysis relook
Study area near American Falls, ID overlaying Idaho map
and NARR downward longwave radiation for north America
for May 17, 2008
North American Regional Reanalysis

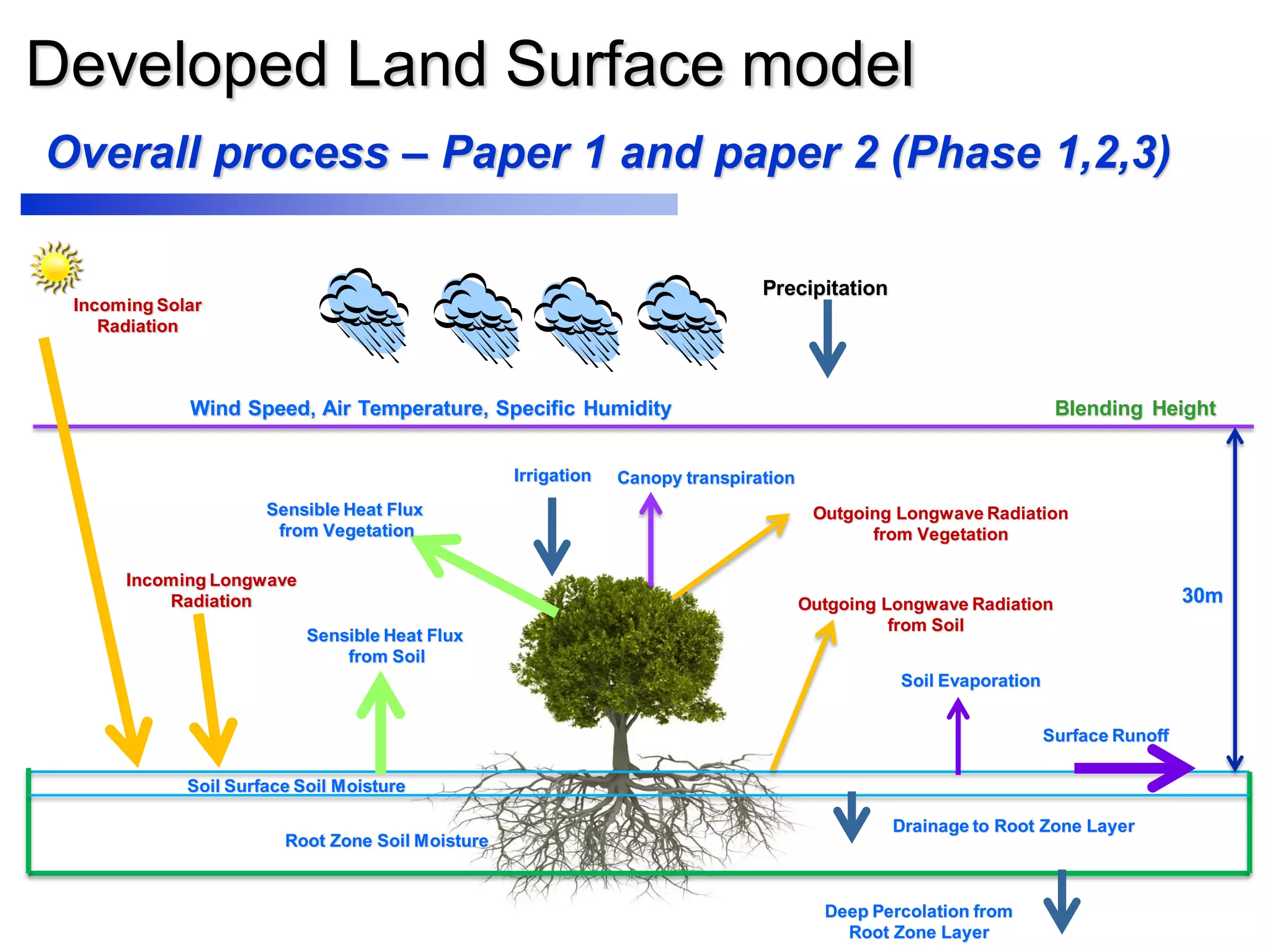

Developed Land Surface model
Wind Speed, Air Temperature, Specific Humidity Blending Height
30m
Incoming Solar
Radiation
Incoming Longwave
Radiation Outgoing Longwave Radiation
from Soil
Outgoing Longwave Radiation
from Vegetation
Soil Evaporation
Canopy transpiration
Root Zone Soil Moisture
Soil Surface Soil Moisture
Precipitation
Sensible Heat Flux
from Soil
Sensible Heat Flux
from Vegetation
Surface Runoff
Drainage to Root Zone Layer
Deep Percolation from
Root Zone Layer
Irrigation

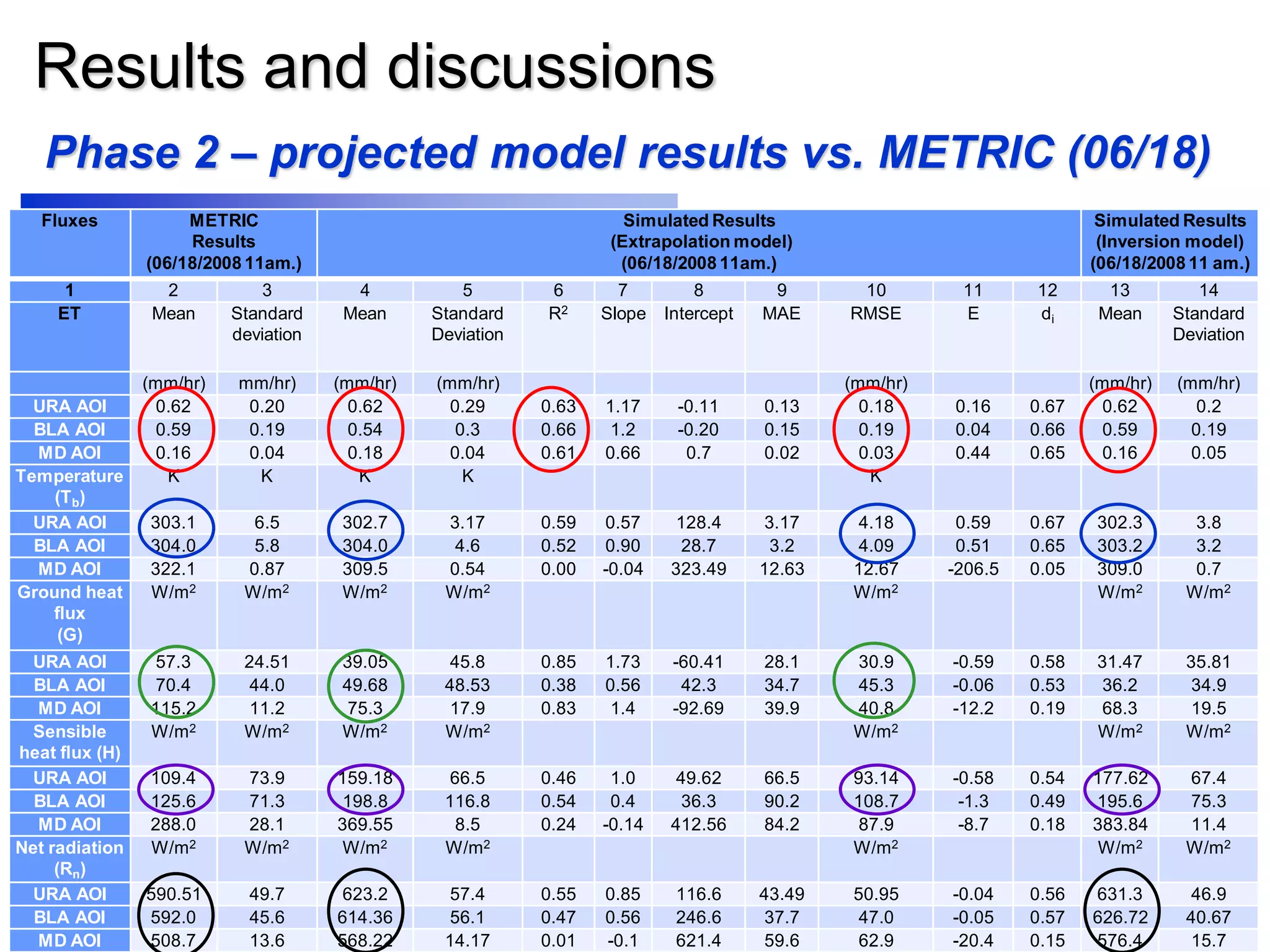

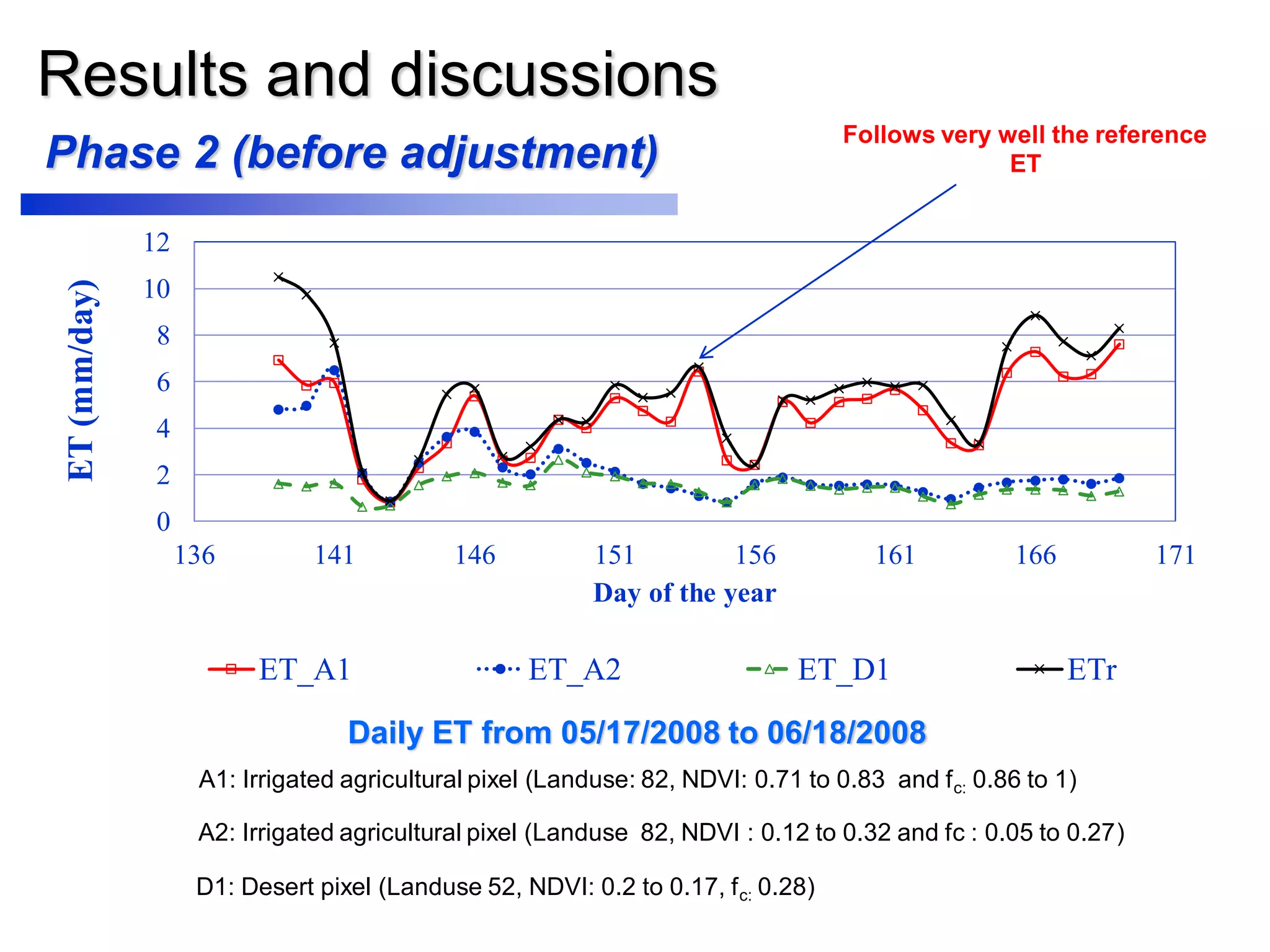

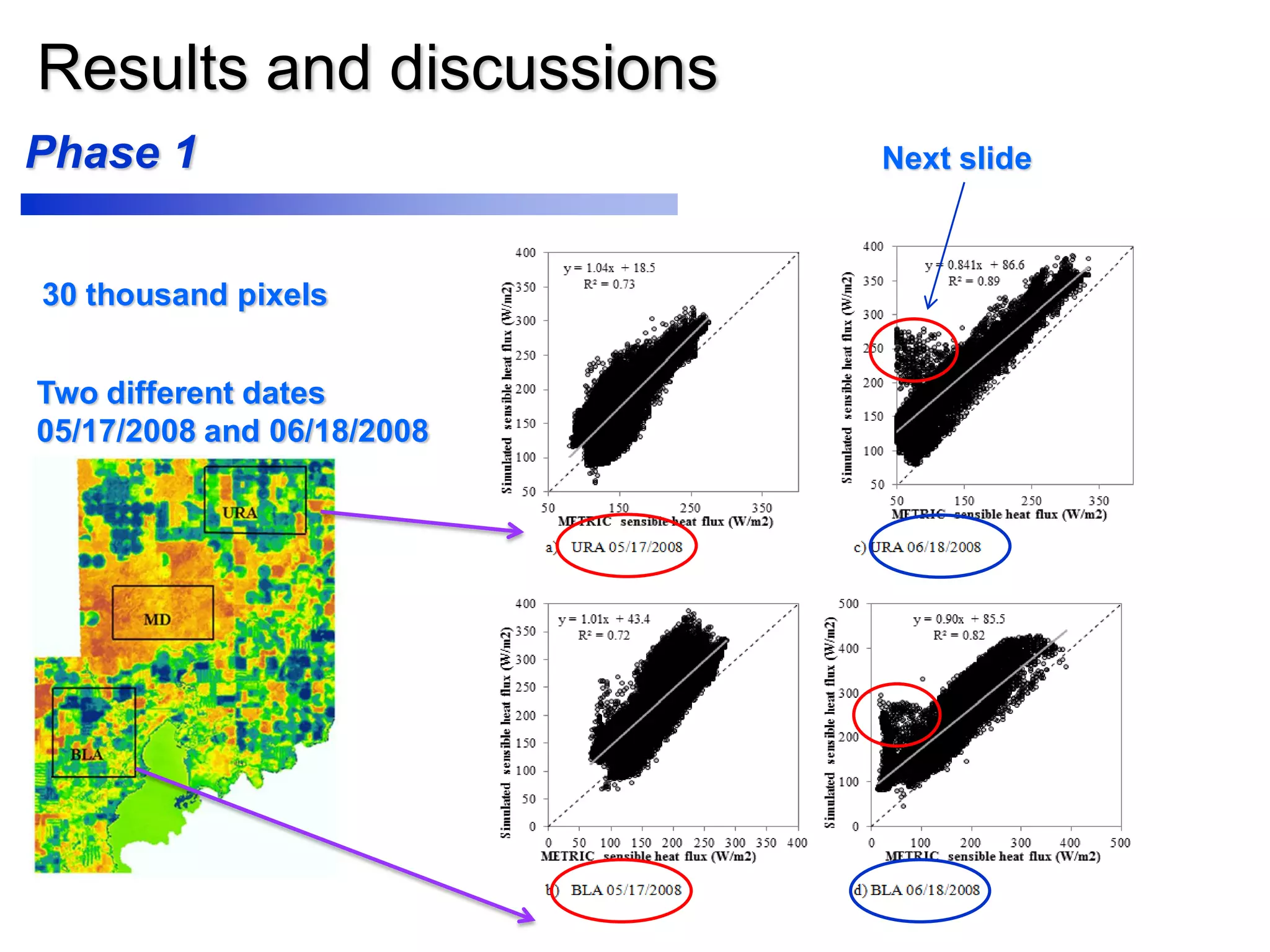

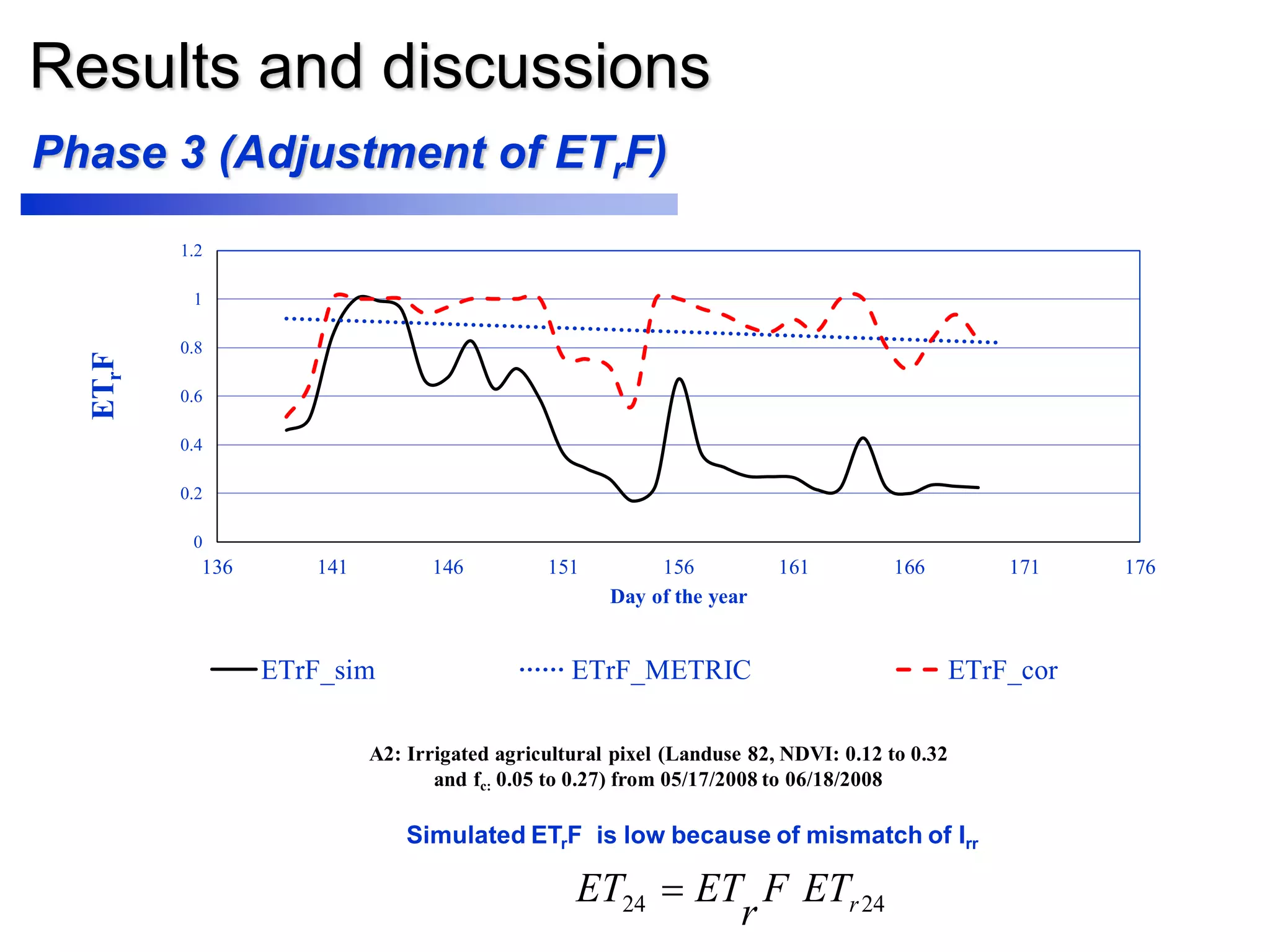

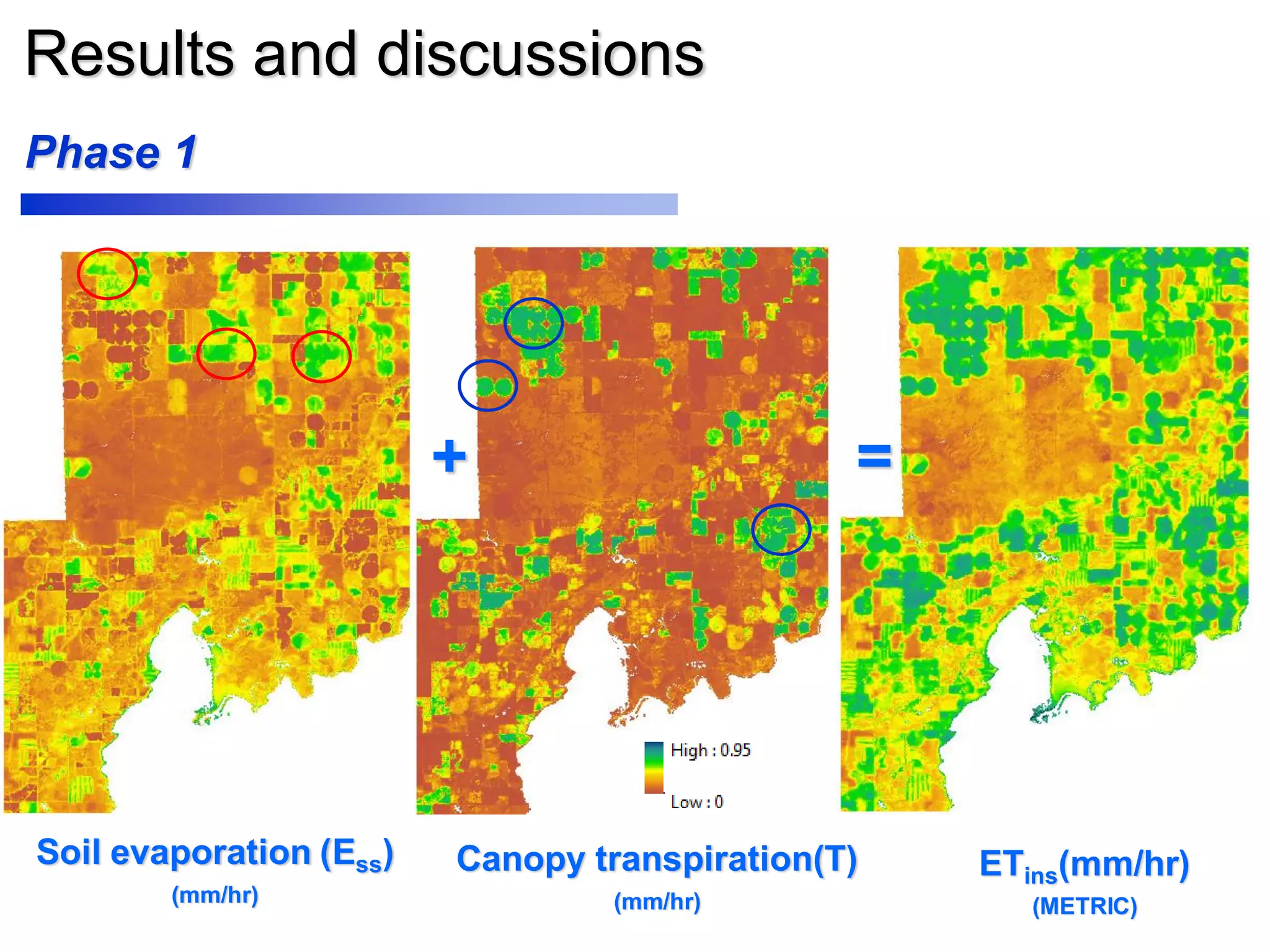

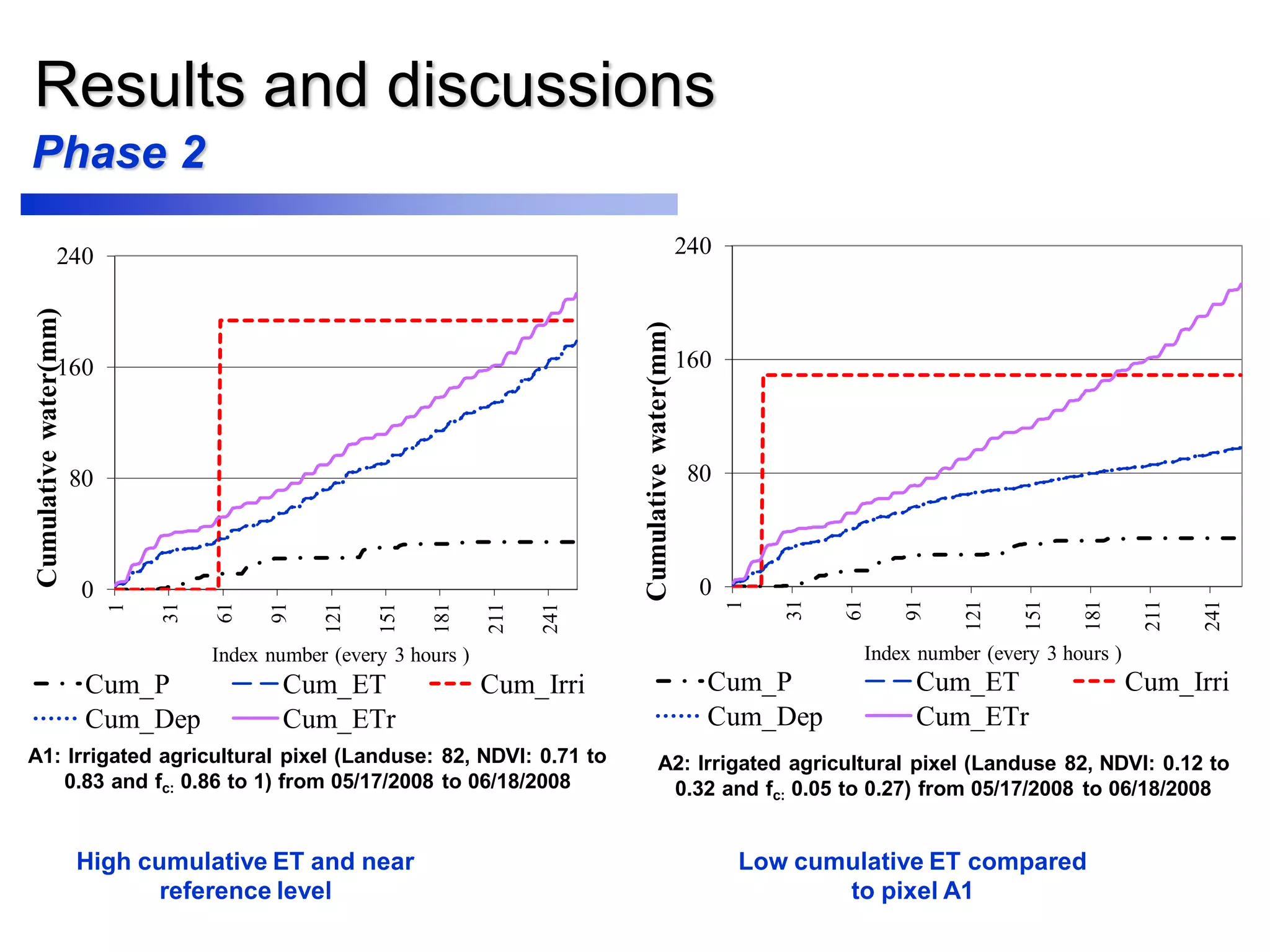

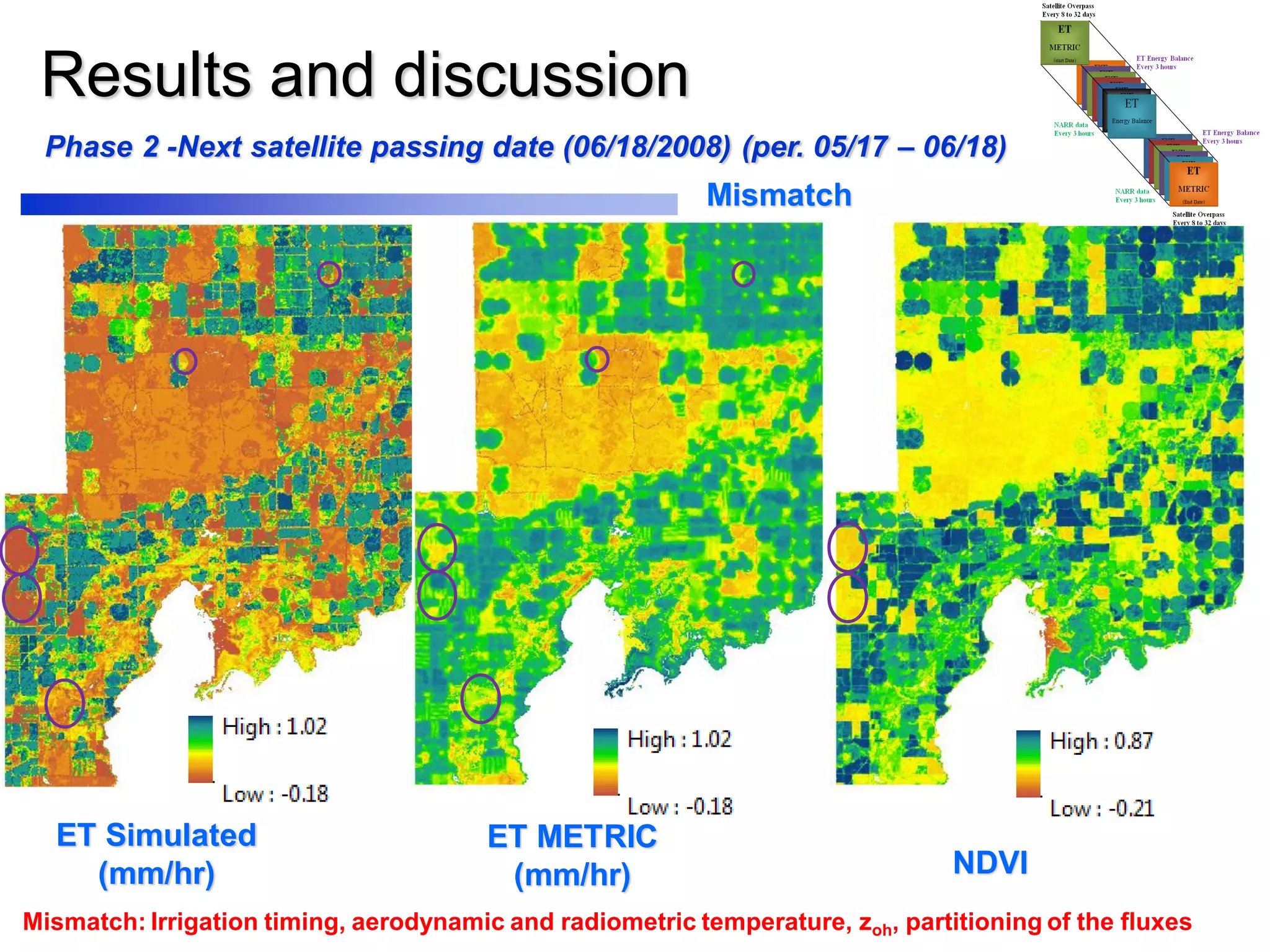

Overall process – Paper 1 and paper 2 (Phase 1,2,3)

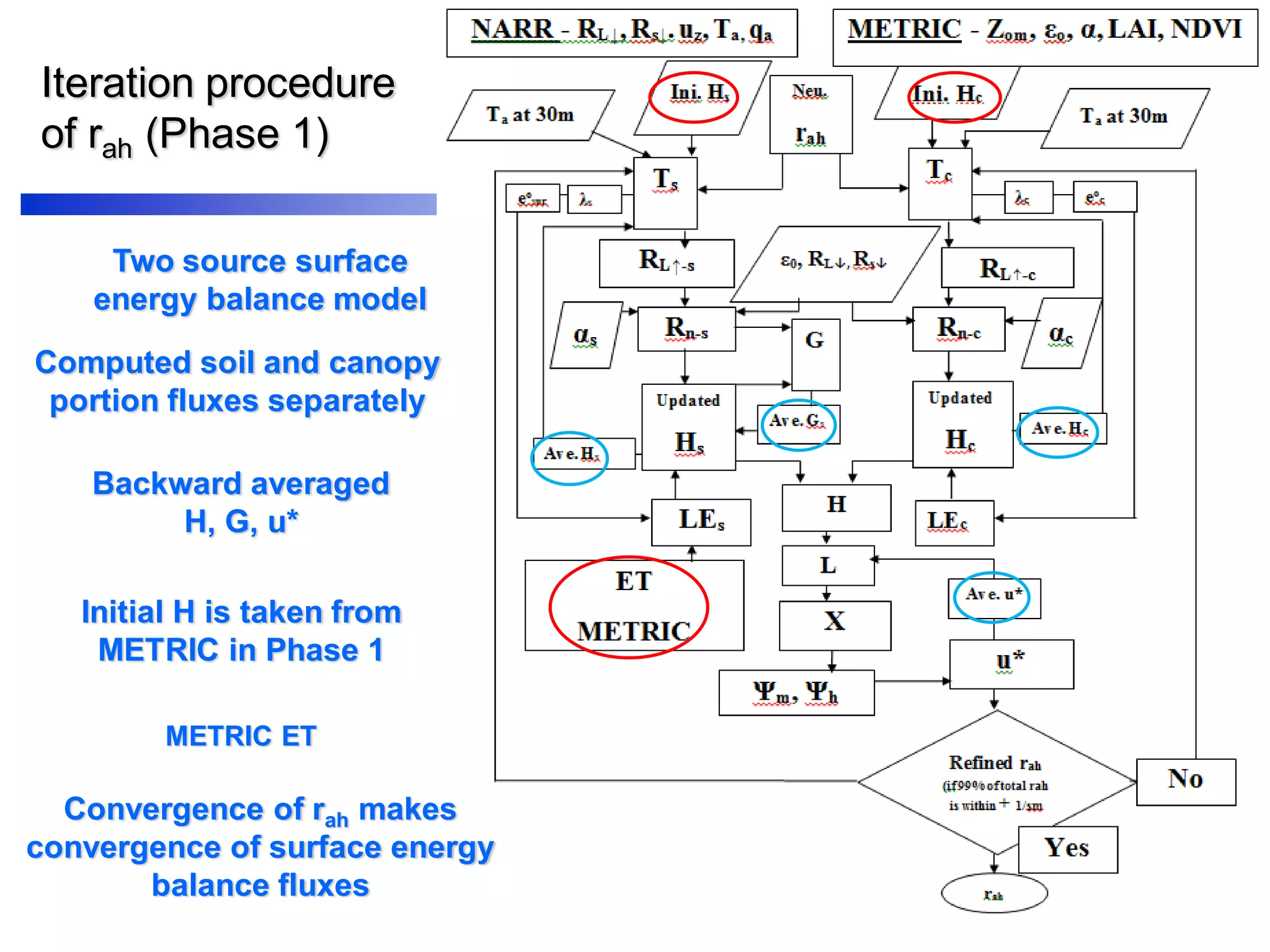

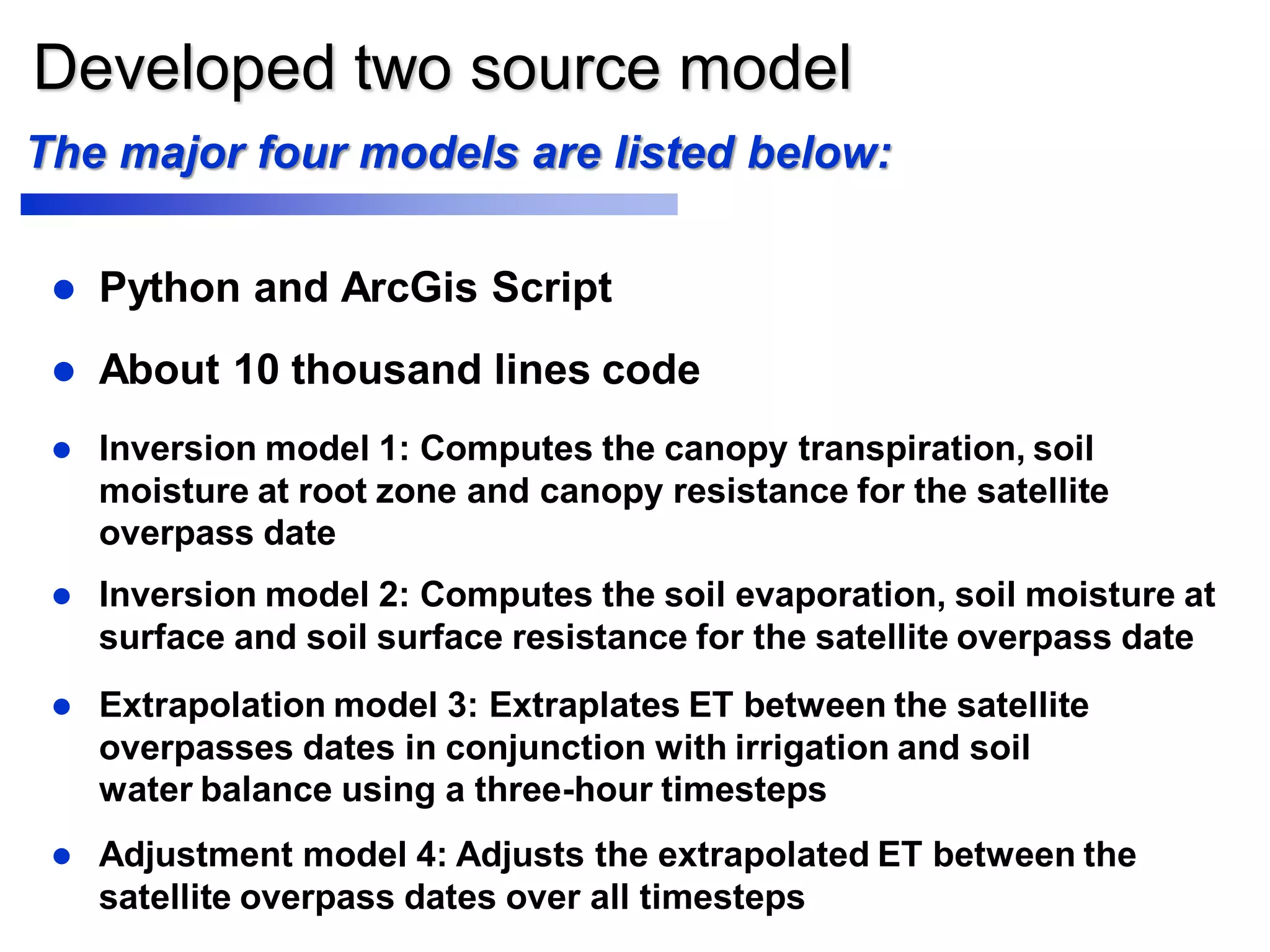

Developed two source model
 Inversion model 1: Computes the canopy transpiration, soil
moisture at root zone and canopy resistance for the satellite
overpass date
 Inversion model 2: Computes the soil evaporation, soil moisture at
surface and soil surface resistance for the satellite overpass date

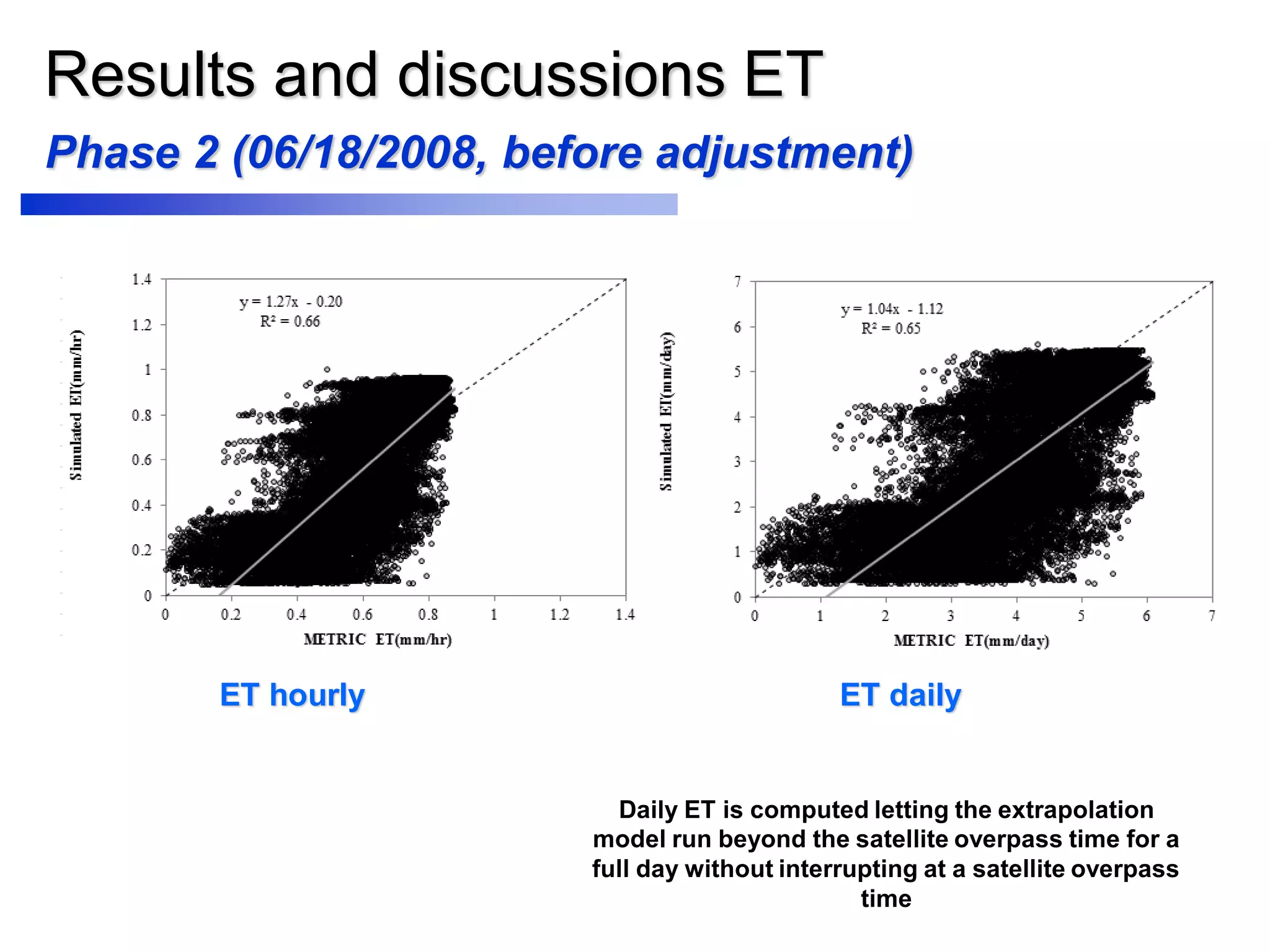

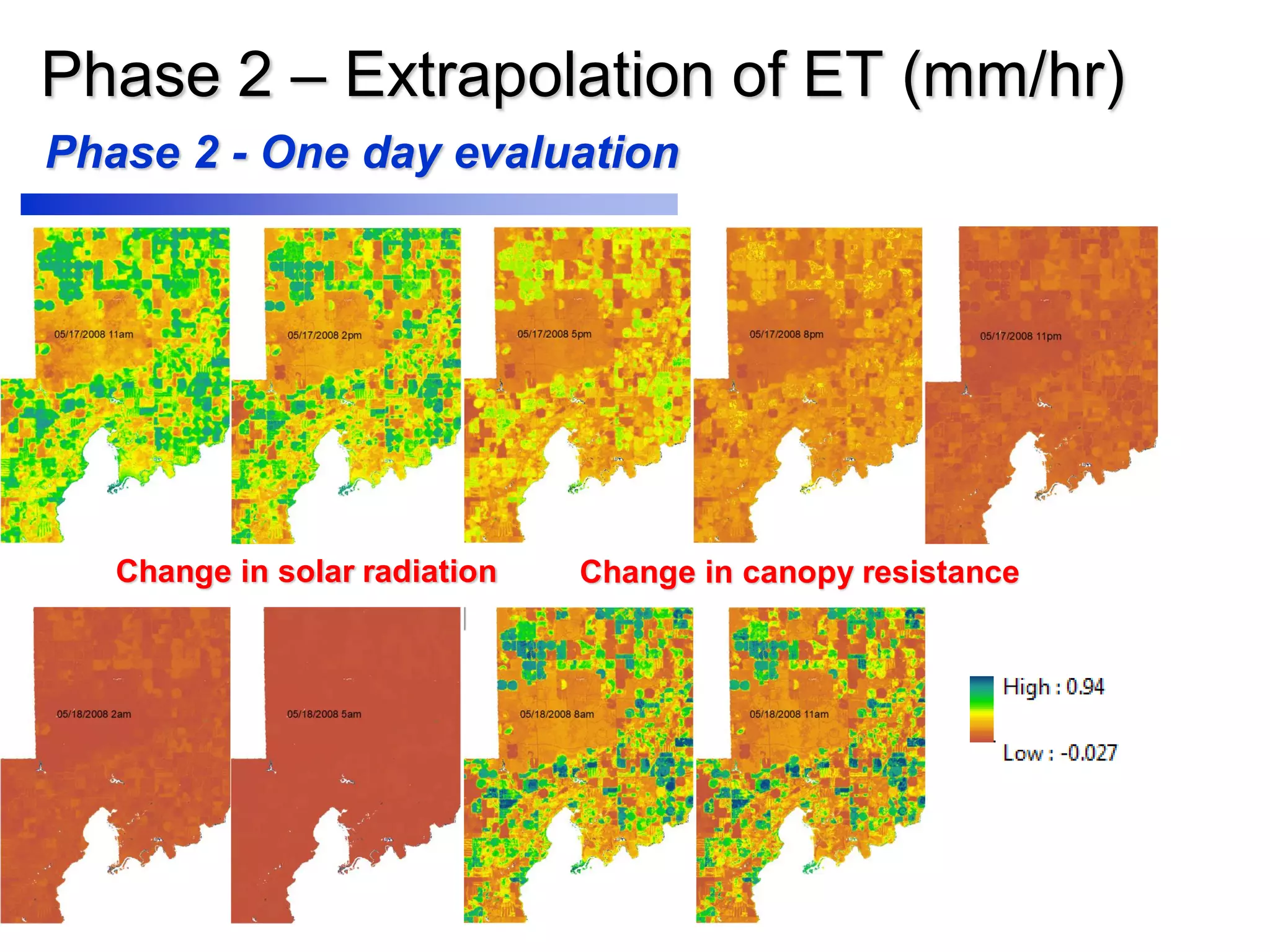

 Extrapolation model 3: Extraplates ET between the satellite
overpasses dates in conjunction with irrigation and soil
water balance using a three-hour timesteps

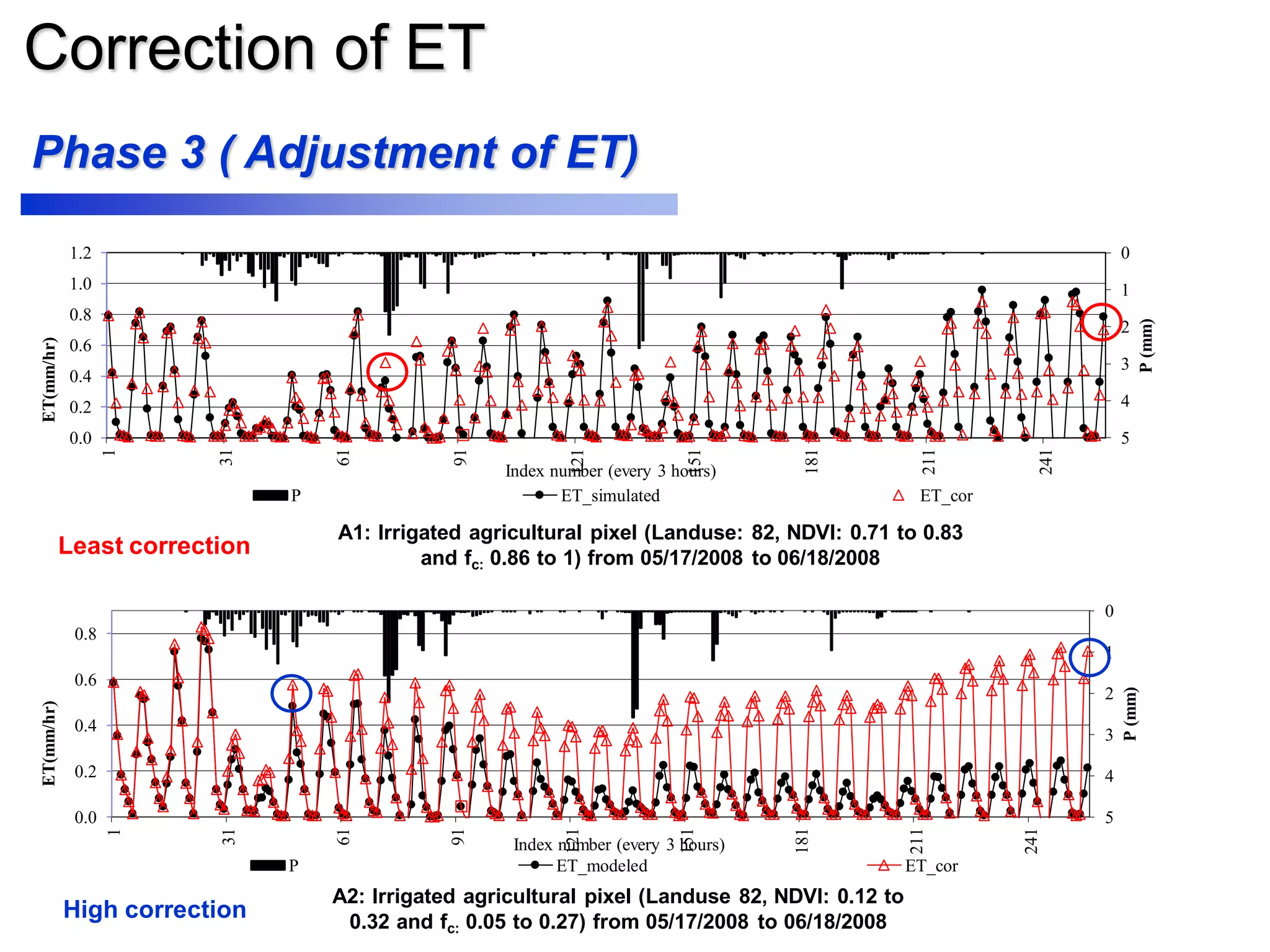

 Adjustment model 4: Adjusts the extrapolated ET between the
satellite overpass dates over all timesteps
The major four models are listed below:
 Python and ArcGis Script
 About 10 thousand lines code

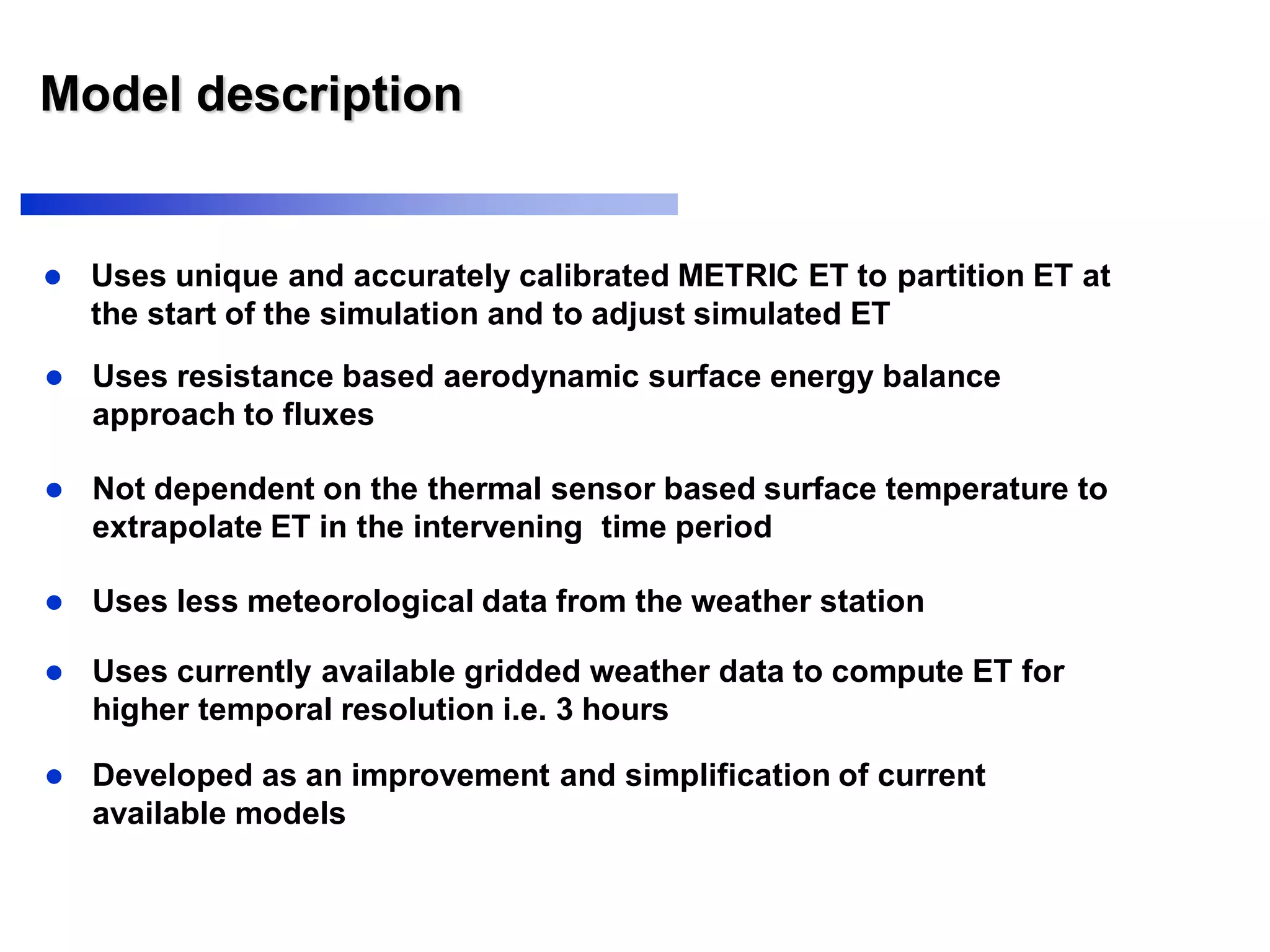

Model description
 Uses unique and accurately calibrated METRIC ET to partition ET at
the start of the simulation and to adjust simulated ET
 Uses resistance based aerodynamic surface energy balance
approach to fluxes
 Not dependent on the thermal sensor based surface temperature to
extrapolate ET in the intervening time period
 Uses less meteorological data from the weather station
 Uses currently available gridded weather data to compute ET for
higher temporal resolution i.e. 3 hours
 Developed as an improvement and simplification of current
available models

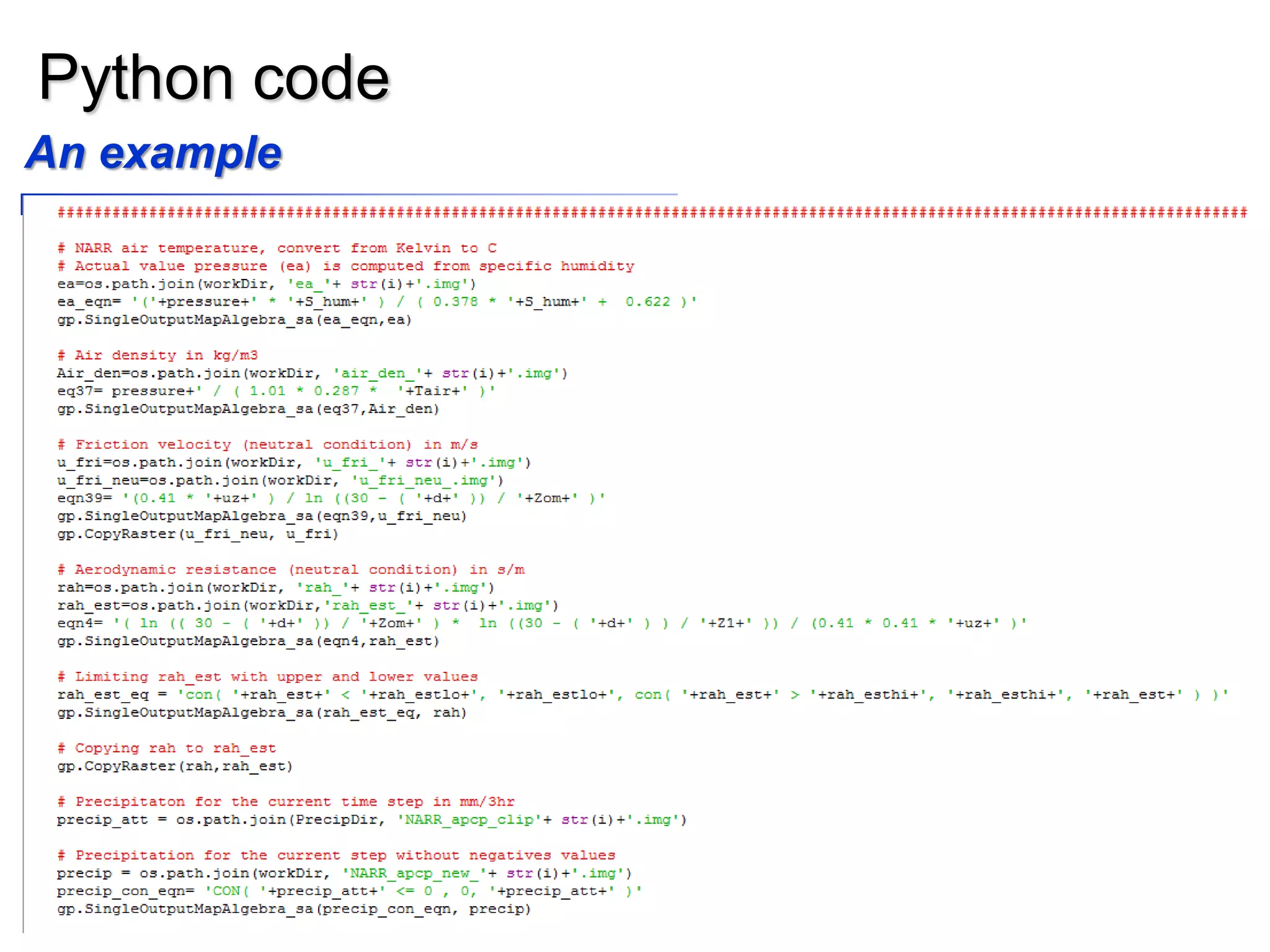

Python code
An example

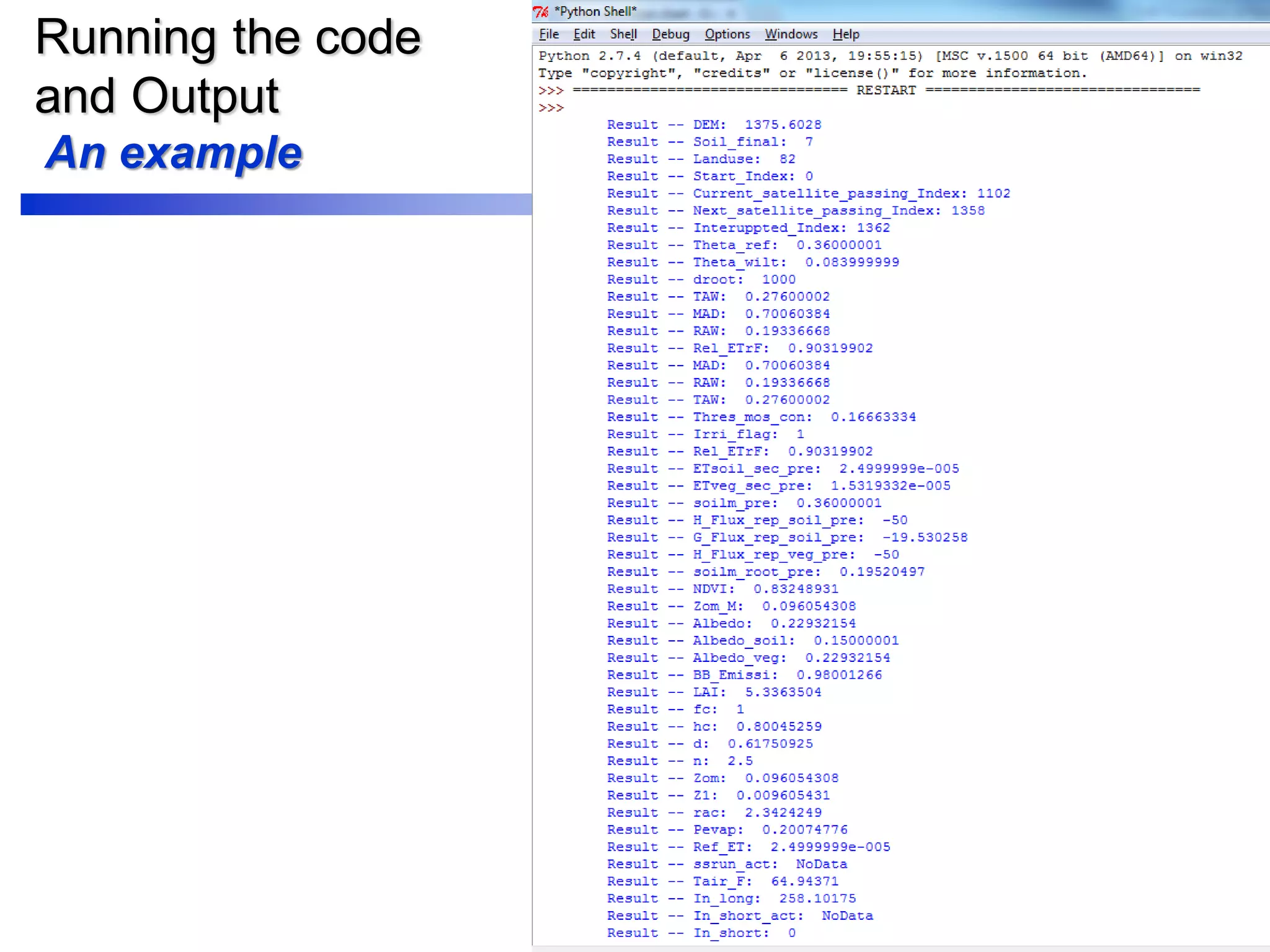

Running the code
and Output
An example

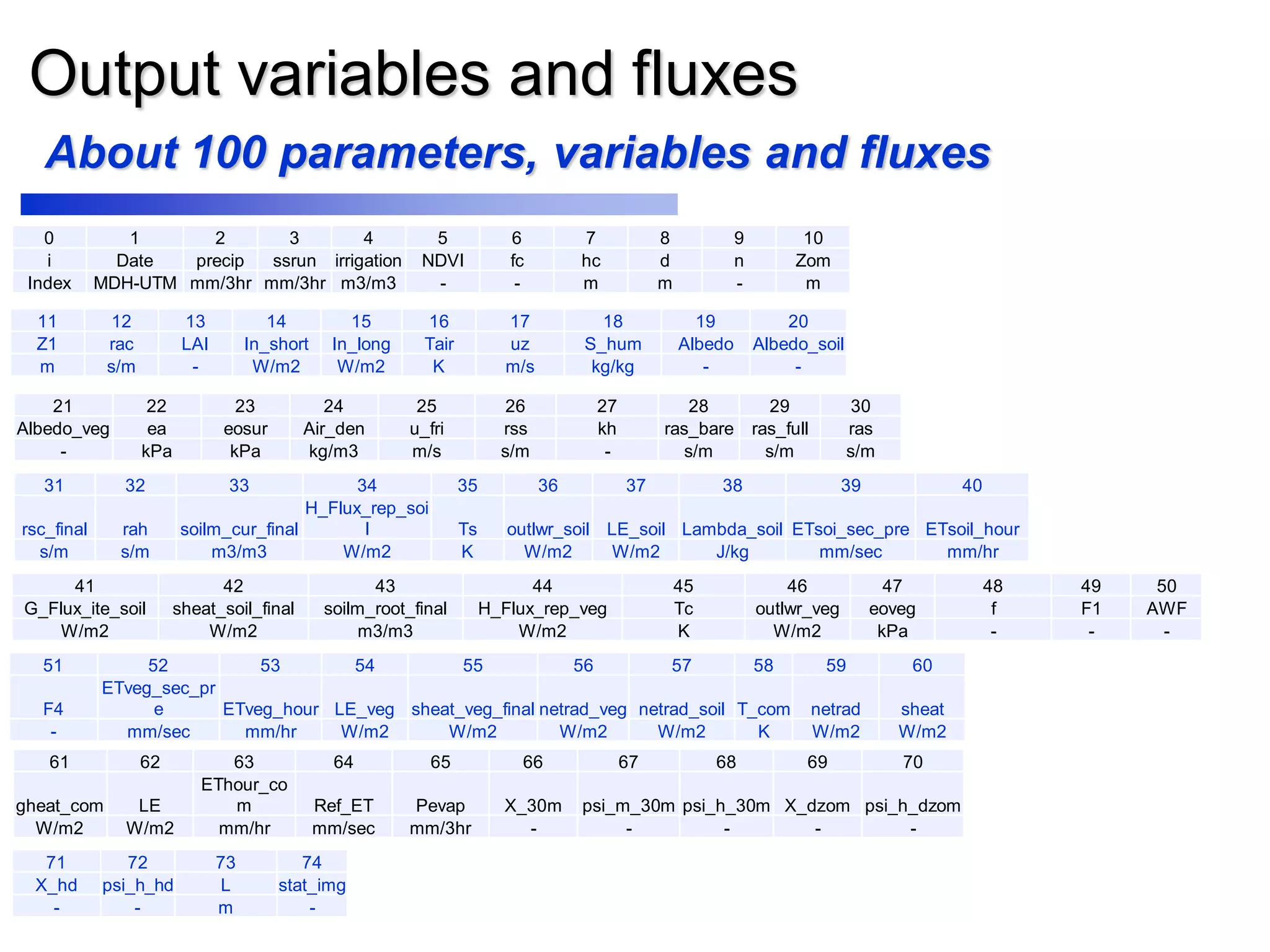

Output variables and fluxes
0 1 2 3 4 5 6 7 8 9 10
i Date precip ssrun irrigation NDVI fc hc d n Zom
Index MDH-UTM mm/3hr mm/3hr m3/m3 - - m m - m
11 12 13 14 15 16 17 18 19 20
Z1 rac LAI In_short In_long Tair uz S_hum Albedo Albedo_soil
m s/m - W/m2 W/m2 K m/s kg/kg - -
21 22 23 24 25 26 27 28 29 30
Albedo_veg ea eosur Air_den u_fri rss kh ras_bare ras_full ras
- kPa kPa kg/m3 m/s s/m - s/m s/m s/m
31 32 33 34 35 36 37 38 39 40
rsc_final rah soilm_cur_final
H_Flux_rep_soi
l Ts outlwr_soil LE_soil Lambda_soil ETsoi_sec_pre ETsoil_hour
s/m s/m m3/m3 W/m2 K W/m2 W/m2 J/kg mm/sec mm/hr
41 42 43 44 45 46 47 48 49 50
G_Flux_ite_soil sheat_soil_final soilm_root_final H_Flux_rep_veg Tc outlwr_veg eoveg f F1 AWF
W/m2 W/m2 m3/m3 W/m2 K W/m2 kPa - - -
51 52 53 54 55 56 57 58 59 60
F4
ETveg_sec_pr
e ETveg_hour LE_veg sheat_veg_final netrad_veg netrad_soil T_com netrad sheat
- mm/sec mm/hr W/m2 W/m2 W/m2 W/m2 K W/m2 W/m2
61 62 63 64 65 66 67 68 69 70
gheat_com LE
EThour_co
m Ref_ET Pevap X_30m psi_m_30m psi_h_30m X_dzom psi_h_dzom
W/m2 W/m2 mm/hr mm/sec mm/3hr - - - - -
71 72 73 74
X_hd psi_h_hd L stat_img
- - m -
About 100 parameters, variables and fluxes
Variables
and fluxes
used in
models

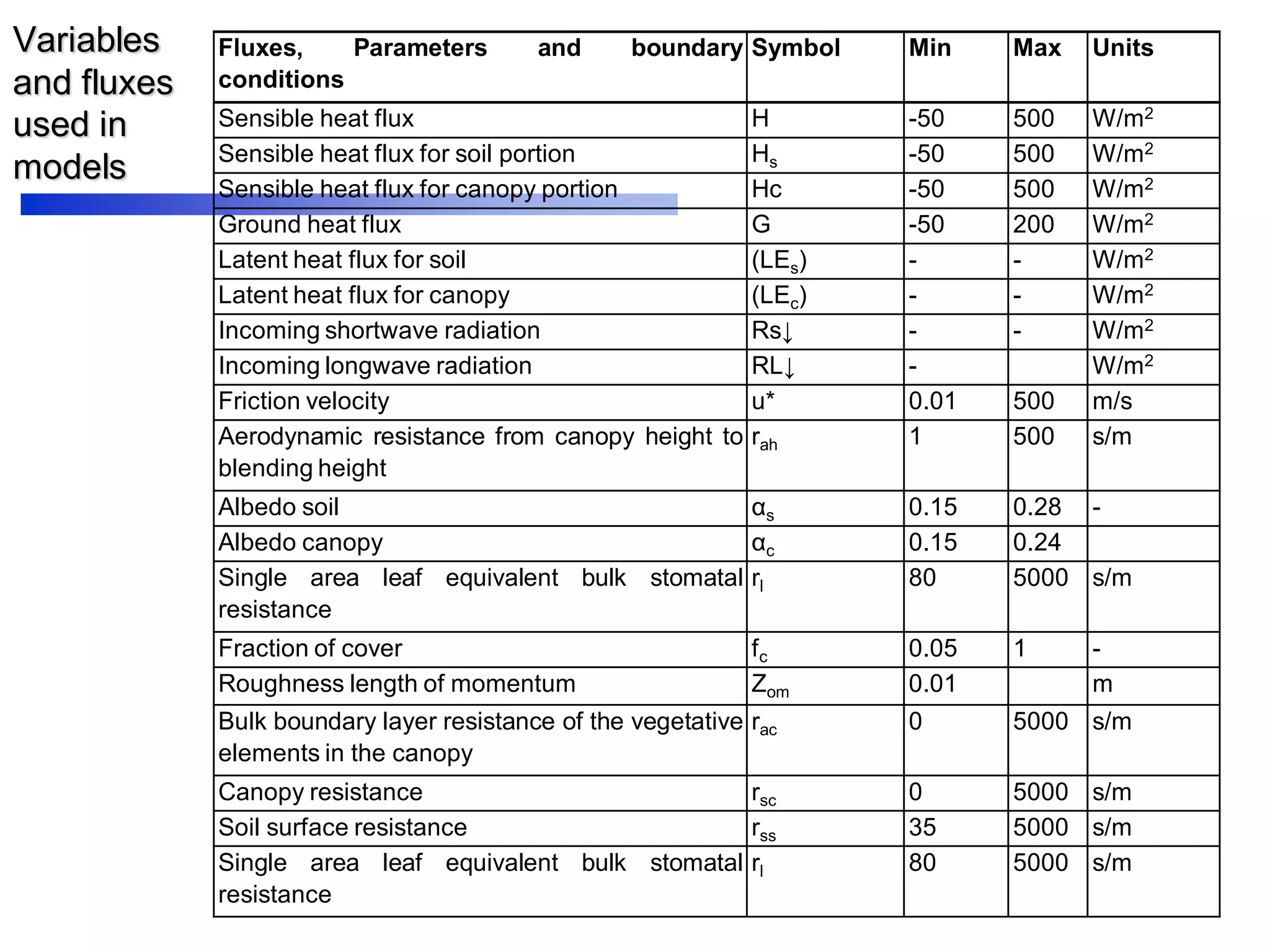

Fluxes, Parameters and boundary
conditions
Symbol Min Max Units
Sensible heat flux H -50 500 W/m2
Sensible heat flux for soil portion Hs -50 500 W/m2
Sensible heat flux for canopy portion Hc -50 500 W/m2
Ground heat flux G -50 200 W/m2
Latent heat flux for soil (LEs) - - W/m2
Latent heat flux for canopy (LEc) - - W/m2
Incoming shortwave radiation Rs↓ - - W/m2
Incoming longwave radiation RL↓ - W/m2
Friction velocity u* 0.01 500 m/s
Aerodynamic resistance from canopy height to
blending height
rah 1 500 s/m
Albedo soil αs 0.15 0.28 -
Albedo canopy αc 0.15 0.24
Single area leaf equivalent bulk stomatal
resistance
rl 80 5000 s/m
Fraction of cover fc 0.05 1 -
Roughness length of momentum Zom 0.01 m
Bulk boundary layer resistance of the vegetative
elements in the canopy
rac 0 5000 s/m
Canopy resistance rsc 0 5000 s/m
Soil surface resistance rss 35 5000 s/m
Single area leaf equivalent bulk stomatal
resistance
rl 80 5000 s/m

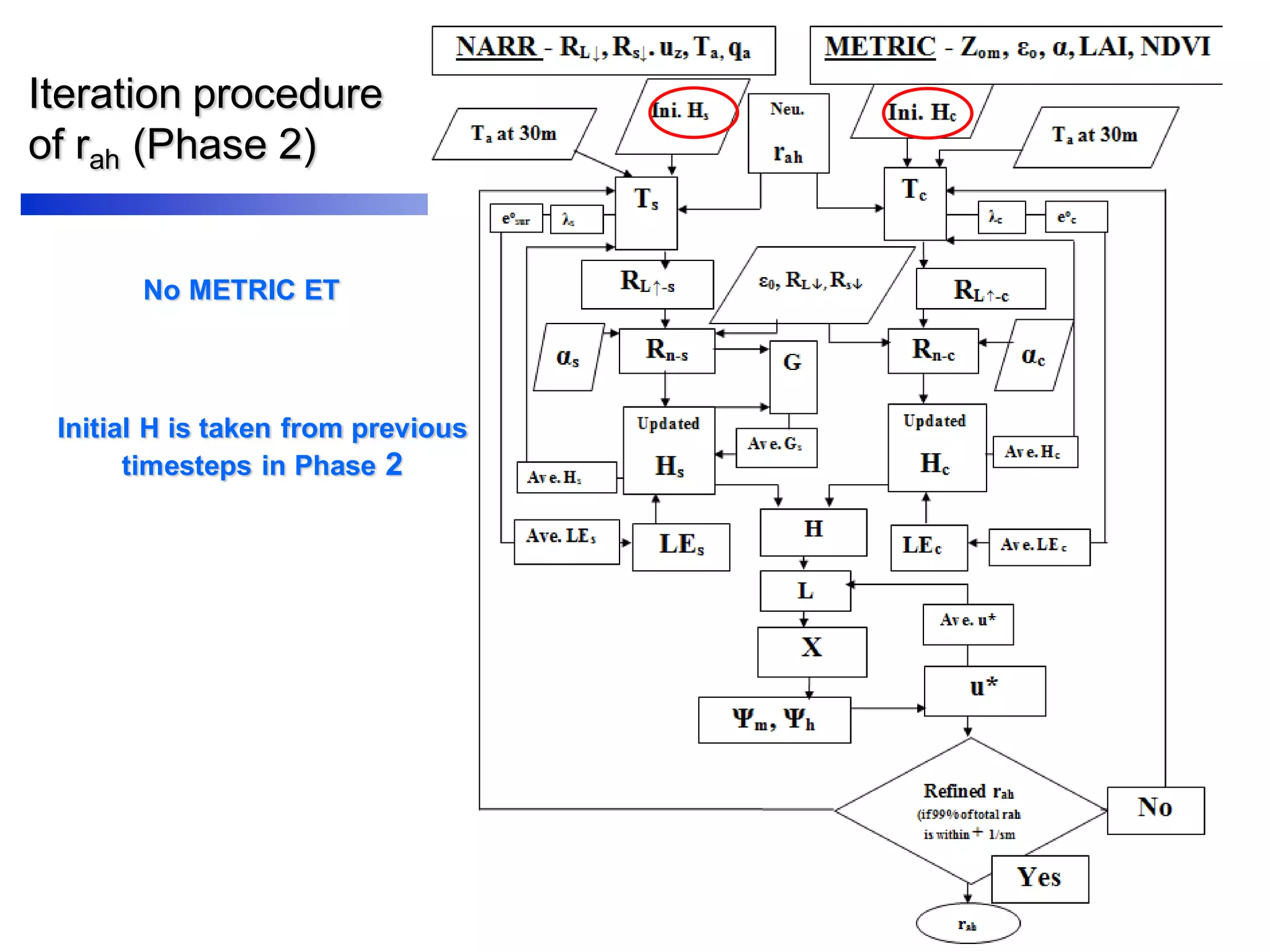

Land surface model

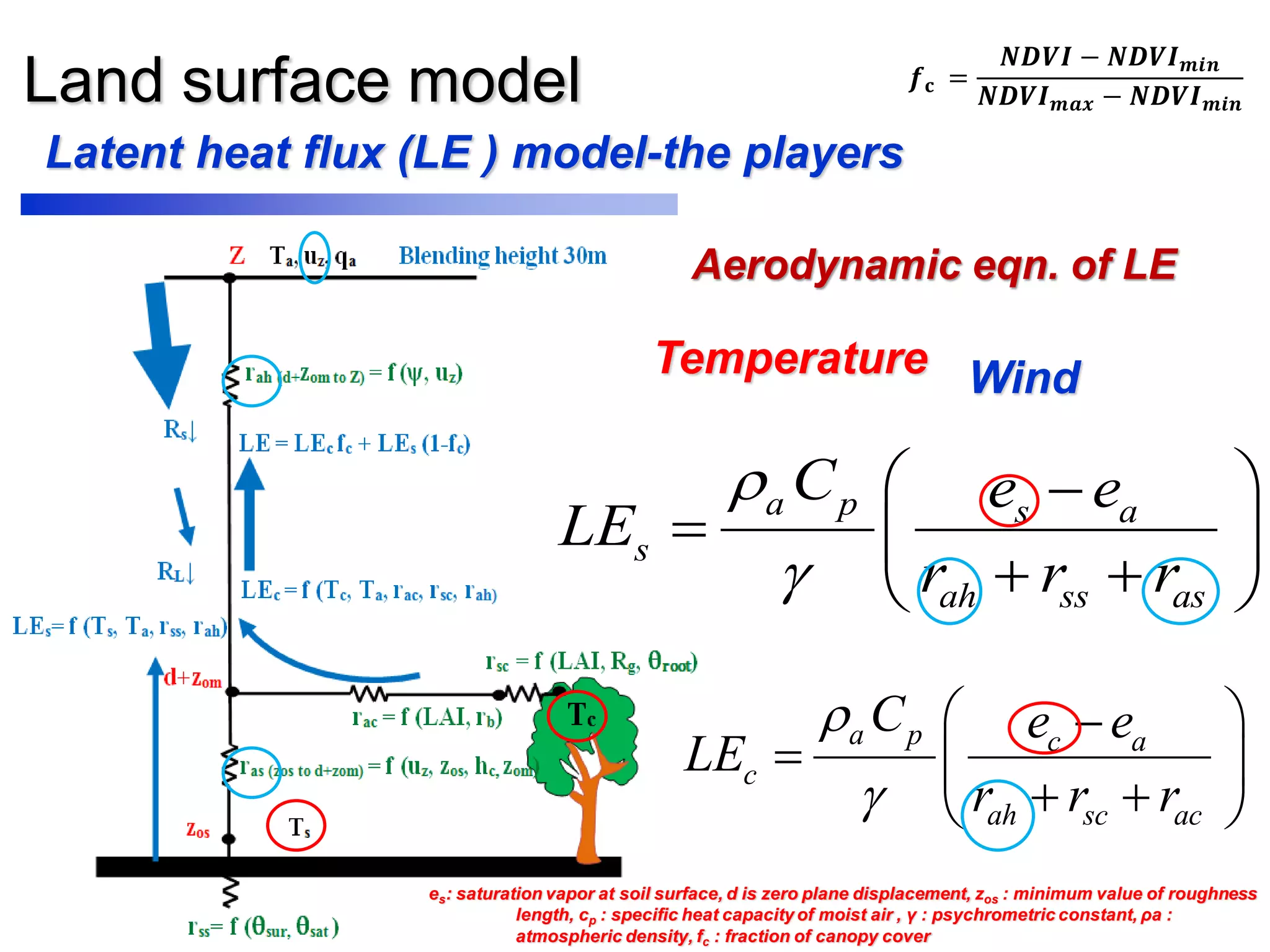

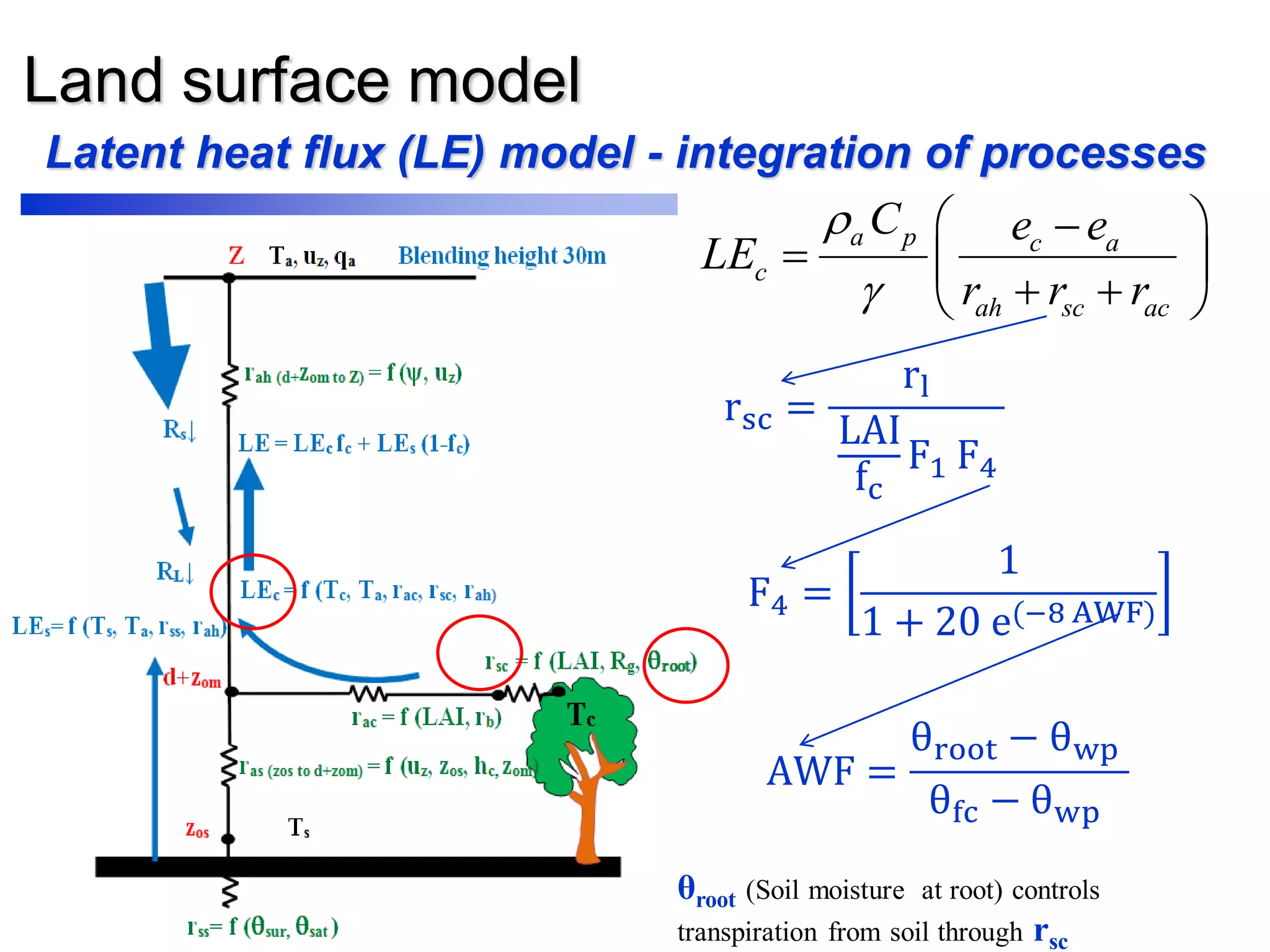

Latent heat flux (LE ) model-the players
a p s a
s
ah ss as
C e e
LE
r r r


 
  
  
WindTemperature
a p c a
c
ah sc ac
C e e
LE
r r r


 
  
  
Aerodynamic eqn. of LE
es: saturation vapor at soil surface, d is zero plane displacement, zos : minimum value of roughness
length, cp : specific heat capacity of moist air , γ : psychrometric constant, ρa :
atmospheric density, fc : fraction of canopy cover
𝒇 𝐜 =
𝑵𝑫𝑽𝑰 − 𝑵𝑫𝑽𝑰 𝒎𝒊𝒏
𝑵𝑫𝑽𝑰 𝒎𝒂𝒙 − 𝑵𝑫𝑽𝑰 𝒎𝒊𝒏
Land Surface model

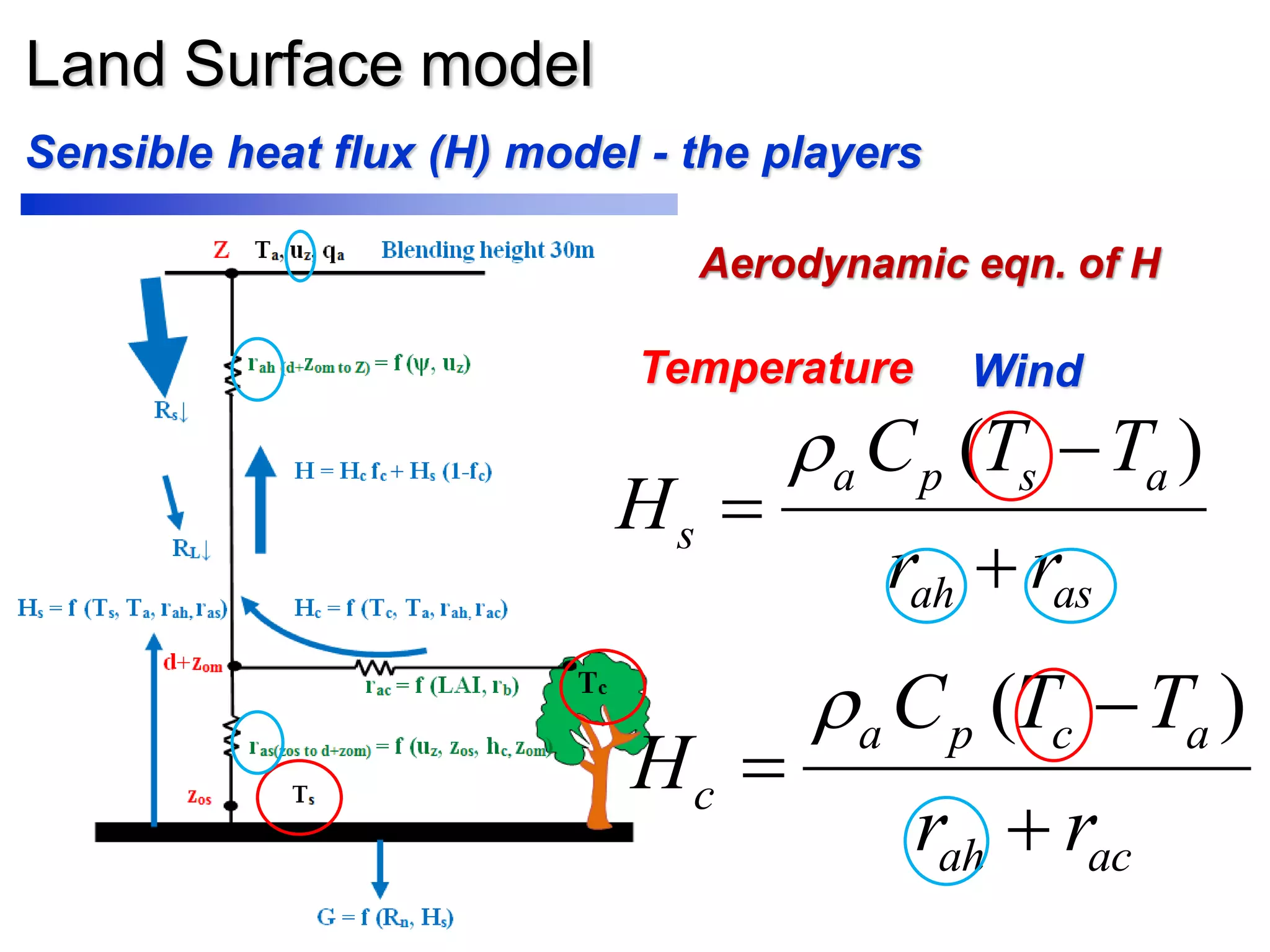

Sensible heat flux (H) model - the players
( )a p s a
s
ah as
C T T
H
r r
 


( )a p c a
c
ah ac
C T T
H
r r
 


Temperature Wind
Aerodynamic eqn. of H
Land Surface model
Latent heat flux (LE) model - integration of processes
rss = 3.5
θsat
θsur
2.3
+ 33.5
θsur (Soil moisture) controls
evaporation from soil through rss
a p s a
s
ah ss as
C e e
LE
r r r


 
  
  
Sun, 1982 (Loam soil)
Land surface model
Latent heat flux (LE) model - integration of processes
a p c a
c
ah sc ac
C e e
LE
r r r


 
  
  
rsc =
rl
LAI
fc
F1 F4
AWF =
θroot − θwp
θfc − θwp
F4 =
1
1 + 20 e(−8 AWF)
θroot (Soil moisture at root) controls
transpiration from soil through rsc
NOAH procedure to calculate F1
l min
l max
1
r
f
r
F
1 f



g
gl
c
R 2
f 0.55
R LAI
f
 
 
 
  
   
  
• r l is bulk stomatal resistance of the well-illuminated
leaf
• Rgl is minimum solar radiation necessary for
photosynthesis (transpiration) to occur
• Rg is incident solar radiation,
• F1 is functions representing the effects of plant stress
due to photosynthetically active radiation (PAR)
• rlmax and rlmin is maximum and minimum value of
single area leaf equivalent bulk stomatal resistance
respectively
l
sc
1 4
c
r
r
LAI
F F
f

Advancement of current
practice of canopy
resistance calculation
Concentrate the multiple
leaf into the canopy
Correction to standard LAI
calculation
Surface Energy balance
Soil Portion Vegetation Portion
_n s s s sR LE G H   _n c c cR LE H 
_max(0.4 ,0.15 )s s n sG H R
( )a p s a
s
ah as
C T T
H
r r
 


( )a p c a
c
ah ac
C T T
H
r r
 


a p s a
s
ah ss as
C e e
LE
r r r


 
  
  
a p c a
c
ah sc ac
C e e
LE
r r r


 
  
  
HGLERn The players
𝐑 𝐧_𝐬
= 𝐑 𝐬↓ − 𝛂 𝐬 𝐑 𝐬↓ + 𝐑 𝐋↓ − 𝐑 𝐋_𝐬↑ − 𝟏 − 𝛆 𝐨_𝐬 𝐑 𝐋↓
RL_s↑ = Ts
4
σ εo_s
𝐑 𝐧_𝐜
= 𝐑 𝐬↓ − 𝛂 𝐬 𝐑 𝐬↓ + 𝐑 𝐋↓ − 𝐑 𝐋_𝐜↑ − 𝟏 − 𝛆 𝐨_𝐜 𝐑 𝐋↓
RL_c↑ = Tc
4
σ εo_c
σ: Stefan-Boltzmann constant
Iteration procedure
of rah (Phase 1)
Backward averaged
H, G, u*
Initial H is taken from
METRIC in Phase 1
Two source surface
energy balance model
Computed soil and canopy
portion fluxes separately
METRIC ET
Convergence of rah makes
convergence of surface energy
balance fluxes
Iteration procedure
of rah (Phase 2)
No METRIC ET
Initial H is taken from previous
timesteps in Phase 2
Inputs from METRIC Model
ETins(mm/hr) NDVI fc
05/17/2008Phase 1
270
278
286
294
302
310
1
31
61
91
121
151
181
211
241
Temperature(K)
Time step number relative to May 17, 2008
Surface Temperature Air Temperature
270
280
290
300
310
320
1
31
61
91
121
151
181
211
241
Temperature(K)
Time step number relative to May 17, 2008
Surface Temperature Air Temperature
Results
A1: Irrigated agricultural pixel (Landuse: 82,
NDVI: 0.71 to 0.83 and fc: 0.86 to 1) from 05/17/2008 to 06/18/2008
A2: Irrigated agricultural pixel (Landuse 82, NDVI: 0.12 to
0.32 and fc: 0.05 to 0.27) from 05/17/2008 to 06/18/2008
Behavior of simulated surface temperature vs. air temperature input
Near neutral condition
Difference between Tb and Ta is larger
than A1
Models Coordinates
(m)
NLCD
Landuse
classes
fc Tb
(K)
H
(W/m2)
G
(W/m2)
Rn
(W/m2)
LE
(W/m2)
METRIC 2612097,
1330202
Agricultural 0.063 305 119 96 641 426
Simulated 303 92 84 603 427
METRIC 2606520,
1327977
Desert 0.28 321 278 111 519 130
Simulated 309 334 78 543 131
METRIC 2604335,
1326667
Grassland 0.19 324 275 110 499 114
Simulated 310 316 93 525 116
METRIC 2600245,
1328521
Agricultural 0.85 301 98 43 600 459
Simulated 303 138 12 609 459
METRIC 2609171,
1333273
Agricultural 0.05 320 250 100 445 95
Simulated 313 284 105 485 96
METRIC 2612312,
1329483
Agricultural 0.24 309 155 90 603 358
Simulated 305 160 64 583 359
Results and discussions

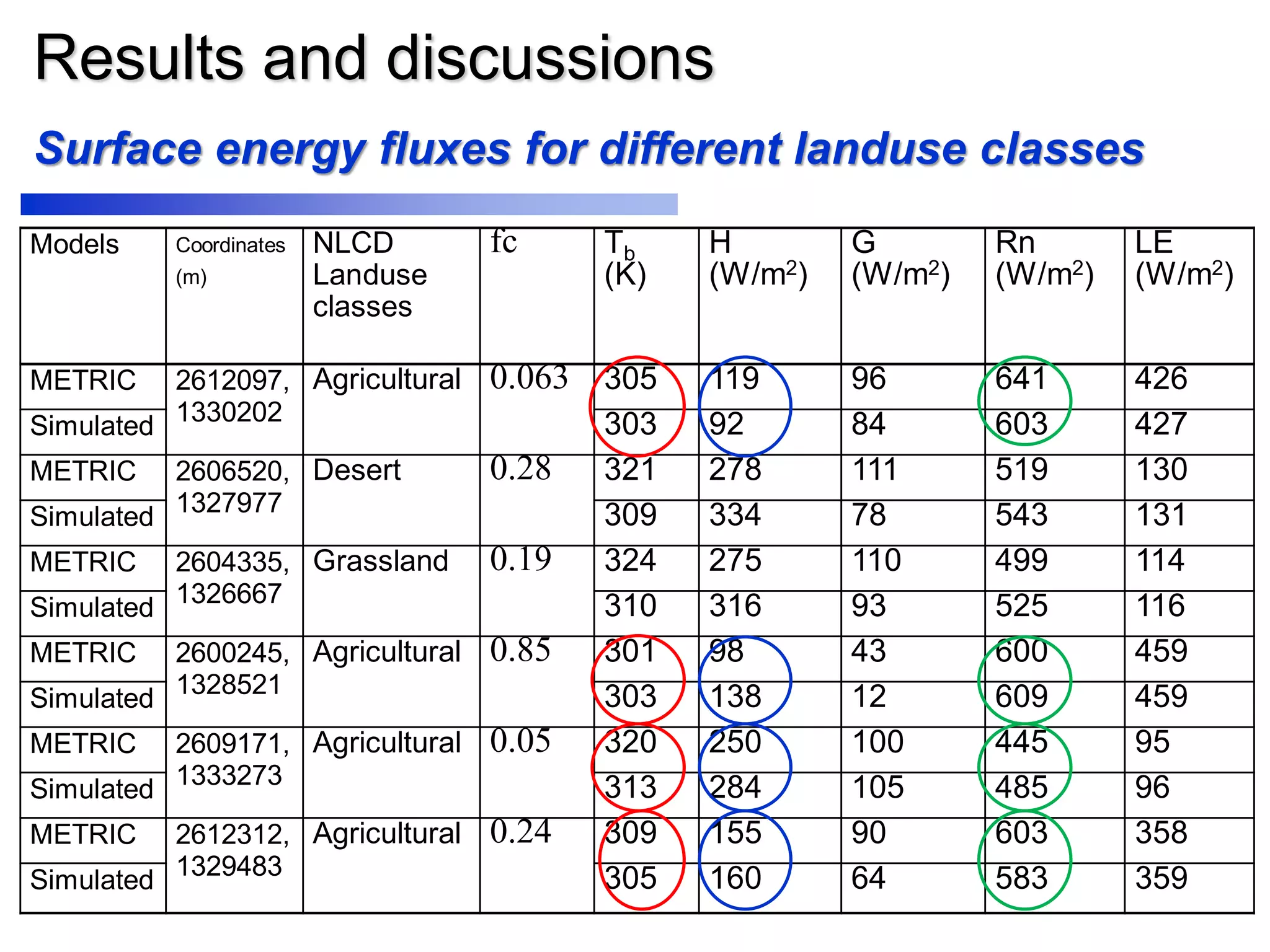

Surface energy fluxes for different landuse classes
Results and discussions
30 thousand pixels
Two different dates
05/17/2008 and 06/18/2008
Phase 1 Next slide

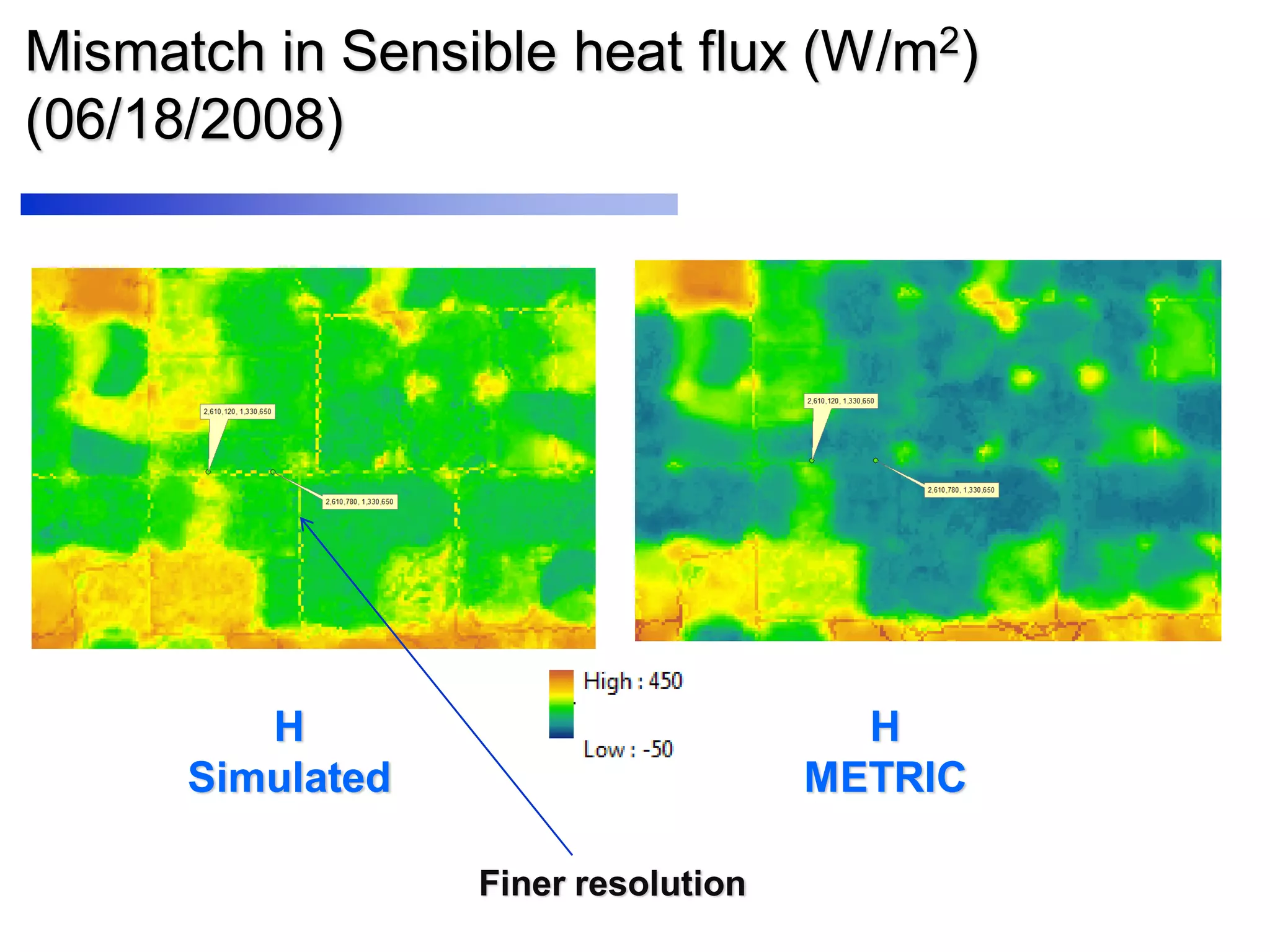

Mismatch in Sensible heat flux (W/m2)
(06/18/2008)
H
Simulated
H
METRIC
Finer resolution
Results and discussions
30 thousand pixels
Two different dates
05/17/2008 and 06/18/2008
Phase 1
Results and discussions
Soil evaporation (Ess)
(mm/hr)
Canopy transpiration(T)
(mm/hr)
ETins(mm/hr)
(METRIC)
Phase 1
+ =
Results and discussions
Soil surface evaporation(rss)
(s/m)
Canopy resistance(rsc)
(s/m)
Phase 1
Low rss
Low rsc
High rsc
High rss
Phase 1 – Inversion of METRIC ET
Parameterize of Soil moisture at surface and root zone
ET METRIC (mm/hr)
Soil moisture at
surface (θss)
(m3/m3)
Soil moisture at
rootzone (θroot)
(m3/m3)
θroot : (0.18-0.22 m3/m3
High θsur
Phase 2 and 3
 Extrapolation of ET
 Calibration of the Model
 Adjustment of ET
Soil water balance
𝛉 𝐬𝐮𝐫(𝐢) =
𝛉 𝐬𝐮𝐫(𝐢−𝟏) +
𝐏(𝐢) + 𝐈 𝐫𝐫(𝐢) − 𝐒 𝐫𝐮𝐧(𝐢) − 𝐄 𝐬𝐬(𝐢)
𝐝 𝐬𝐮𝐫
𝐢𝐟 𝛉𝐬𝐮𝐫𝐢 ≤ 𝛉𝐟𝐜
𝐢𝐟 𝛉𝐬𝐮𝐫𝐢 > 𝛉𝐟𝐜
𝛉𝐟𝐜
𝛉 𝐬𝐮𝐫(𝐢) = 𝛉 𝐬𝐮𝐫(𝐢−𝟏) +
𝐏(𝐢) + 𝐈 𝐫𝐫(𝐢) − 𝐒 𝐫𝐮𝐧(𝐢) − 𝐄 𝐬𝐬(𝐢) − 𝐓𝐞(𝐢)
𝐝 𝐬𝐮𝐫
− 𝐃𝐏𝐞(𝐢) + 𝐂𝐑 𝐞(𝐢)

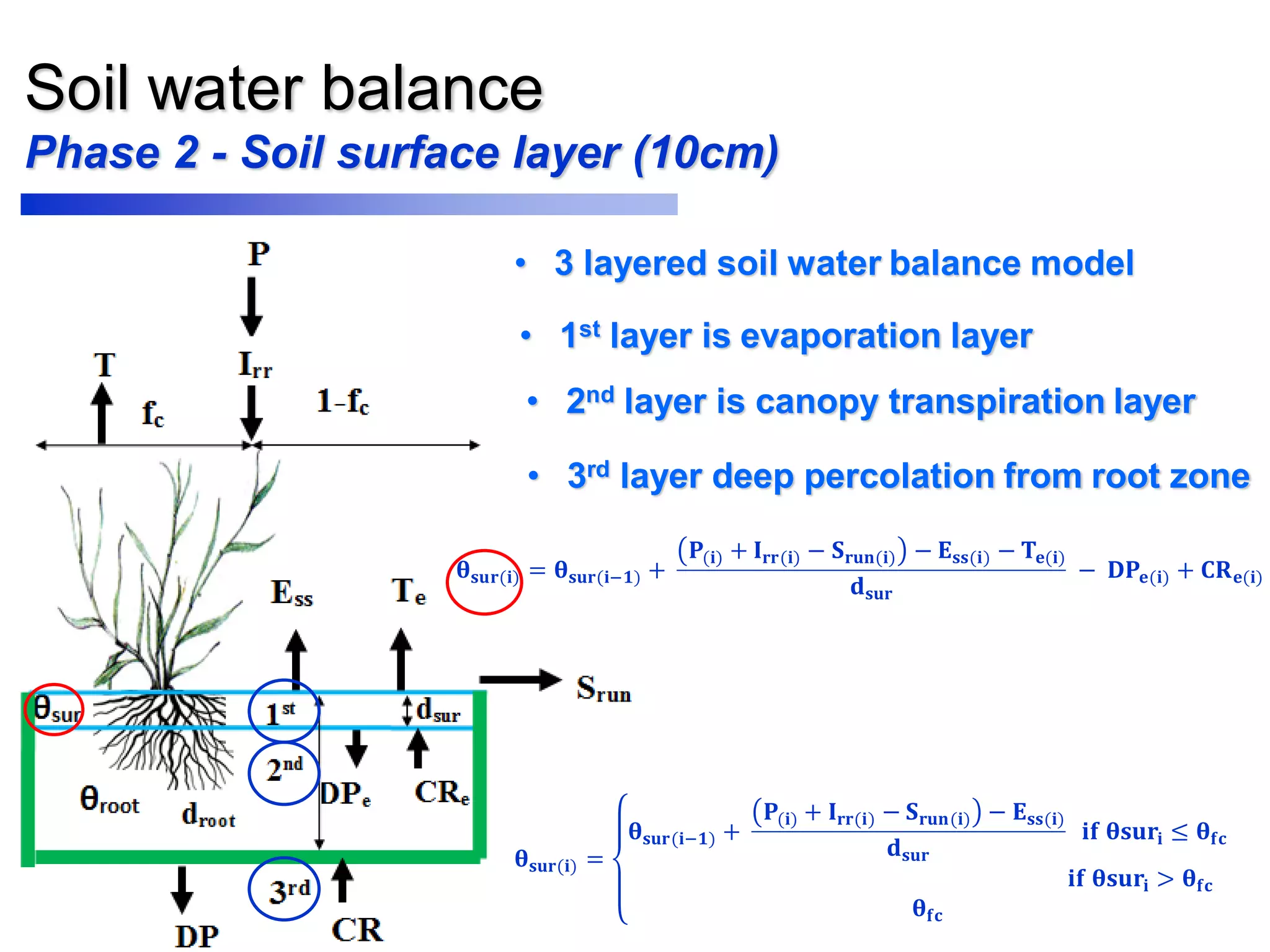

Phase 2 - Soil surface layer (10cm)
• 3 layered soil water balance model
• 1st layer is evaporation layer
• 2nd layer is canopy transpiration layer
• 3rd layer deep percolation from root zone
Soil water balance
𝛉 𝐫𝐨𝐨𝐭(𝐢) =
𝛉 𝐫𝐨𝐨𝐭(𝐢−𝟏) +
𝐏(𝐢) + 𝐈 𝐫𝐫(𝐢) − 𝐒 𝐫𝐮𝐧(𝐢) − 𝐓(𝐢) − 𝐄 𝐬𝐬(𝐢)
𝐝 𝐫𝐨𝐨𝐭
𝐢𝐟 𝛉 𝐫𝐨𝐨𝐭(𝐢) ≤ 𝛉𝐟𝐜
𝛉𝐟𝐜 𝐢𝐟 𝛉 𝐫𝐨𝐨𝐭(𝐢) > 𝛉𝐟𝐜
𝛉 𝐫𝐨𝐨𝐭(𝐢) = 𝛉 𝐫𝐨𝐨𝐭(𝐢−𝟏) +
𝐏(𝐢) + 𝐈 𝐫𝐫(𝐢) − 𝐒 𝐫𝐮𝐧(𝐢) − 𝐓(𝐢) − 𝐄 𝐬𝐬(𝐢)
𝐝 𝐫𝐨𝐨𝐭
− 𝐃𝐏 𝐢 + 𝐂𝐑(𝐢)
Phase 2 - Root zone layer (1-2m)
• 1st (evaporation) layer is subset of 2nd layer
• Sub-setting allows track evaporation from soil surface
and transpiration from root zone simultaneously

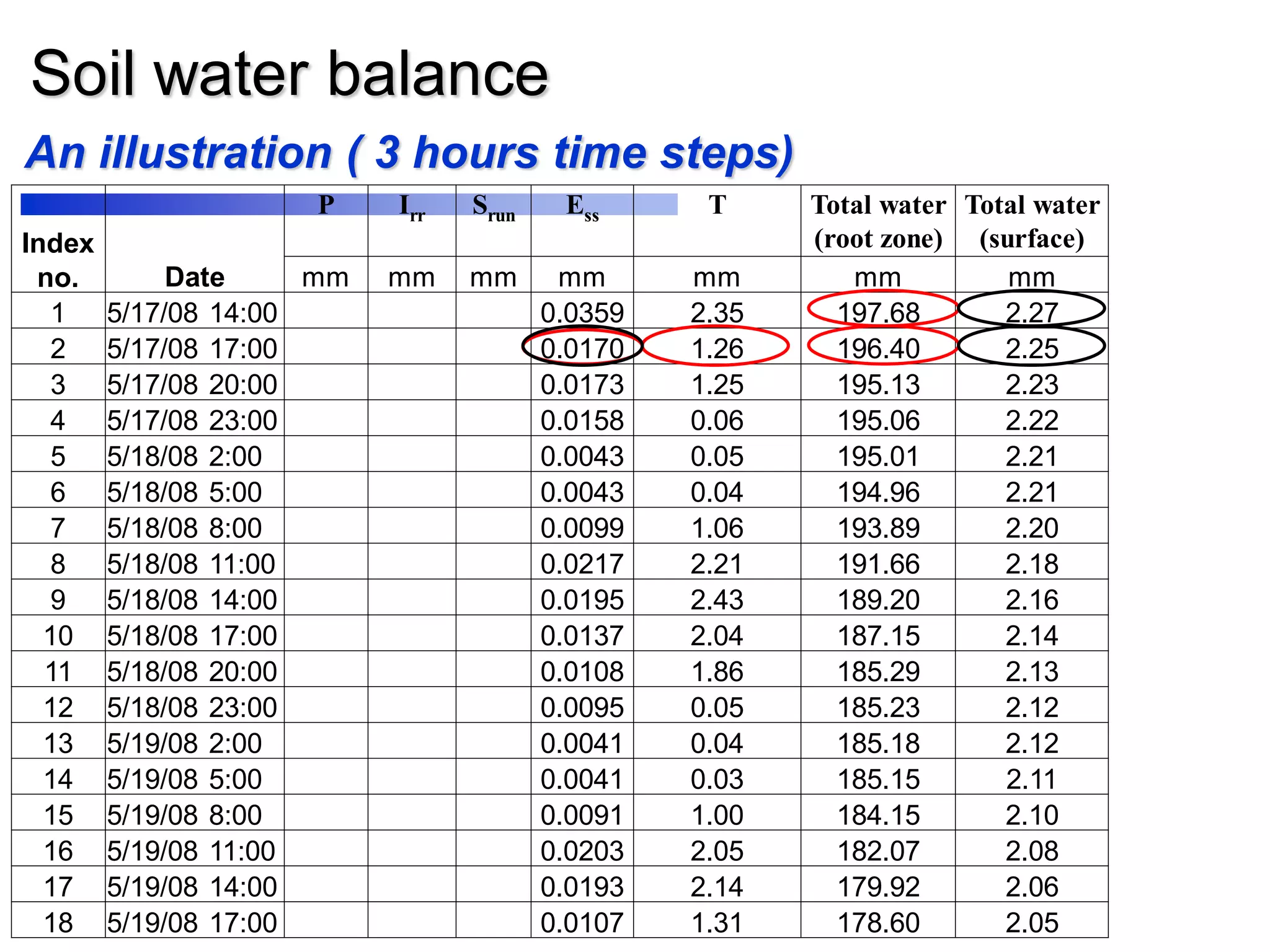

Soil water balance
An illustration ( 3 hours time steps)
Index
no. Date
P Irr Srun Ess T Total water
(root zone)
Total water
(surface)
mm mm mm mm mm mm mm
1 5/17/08 14:00 0.0359 2.35 197.68 2.27
2 5/17/08 17:00 0.0170 1.26 196.40 2.25
3 5/17/08 20:00 0.0173 1.25 195.13 2.23
4 5/17/08 23:00 0.0158 0.06 195.06 2.22
5 5/18/08 2:00 0.0043 0.05 195.01 2.21
6 5/18/08 5:00 0.0043 0.04 194.96 2.21
7 5/18/08 8:00 0.0099 1.06 193.89 2.20
8 5/18/08 11:00 0.0217 2.21 191.66 2.18
9 5/18/08 14:00 0.0195 2.43 189.20 2.16
10 5/18/08 17:00 0.0137 2.04 187.15 2.14
11 5/18/08 20:00 0.0108 1.86 185.29 2.13
12 5/18/08 23:00 0.0095 0.05 185.23 2.12
13 5/19/08 2:00 0.0041 0.04 185.18 2.12
14 5/19/08 5:00 0.0041 0.03 185.15 2.11
15 5/19/08 8:00 0.0091 1.00 184.15 2.10
16 5/19/08 11:00 0.0203 2.05 182.07 2.08
17 5/19/08 14:00 0.0193 2.14 179.92 2.06
18 5/19/08 17:00 0.0107 1.31 178.60 2.05

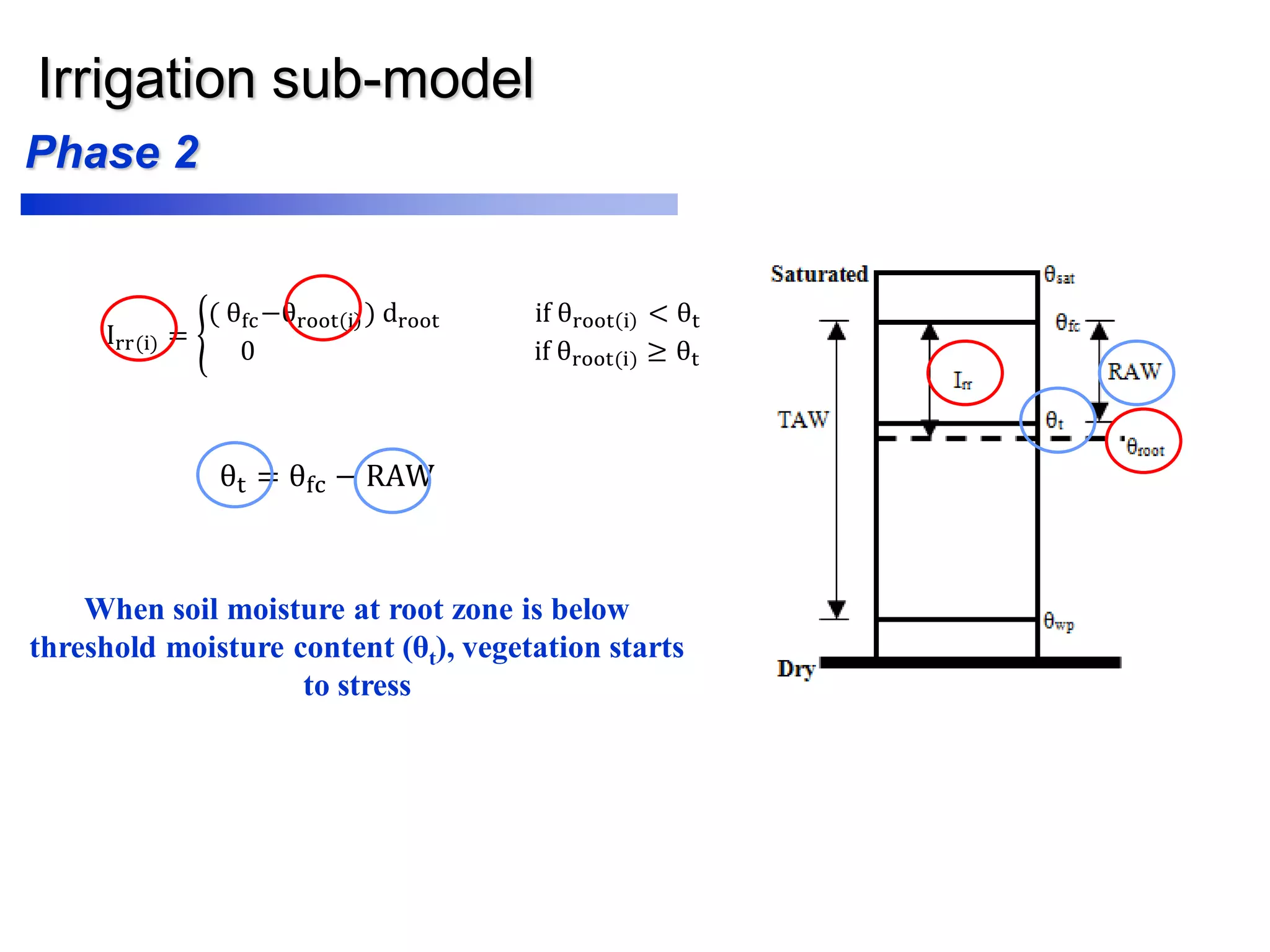

Irrigation sub-model
Irr(i) =
( θfc−θroot i ) droot if θroot i < θt
0 if θroot(i) ≥ θt
θt = θfc − RAW
Phase 2
When soil moisture at root zone is below
threshold moisture content (θt), vegetation starts
to stress

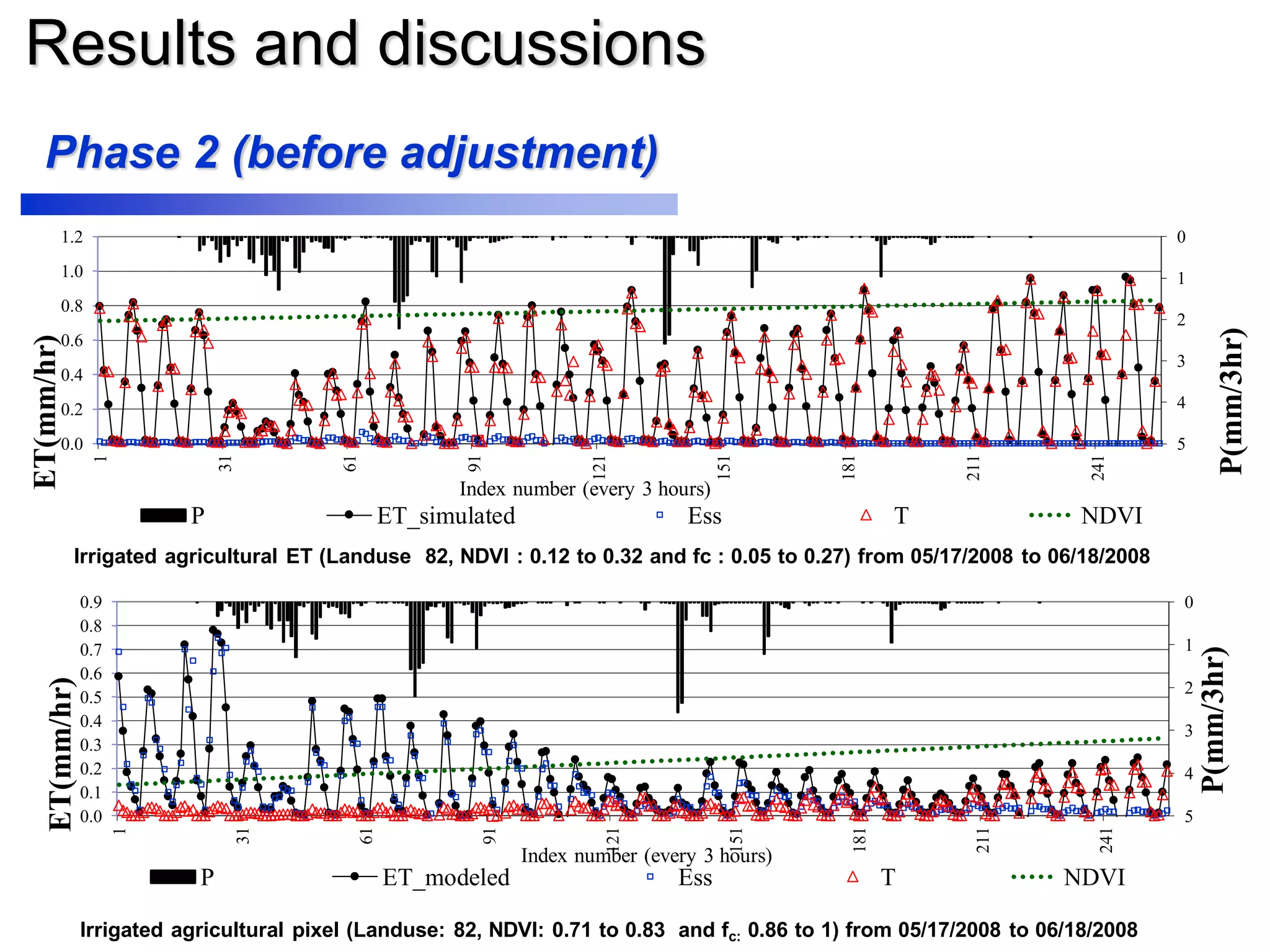

Phase 2 – Extrapolation of ET (mm/hr)
Phase 2 - One day evaluation
Change in solar radiation Change in canopy resistance
Results and discussion
Phase 2 -Next satellite passing date (06/18/2008) (per. 05/17 – 06/18)
ET Simulated
(mm/hr)
ET METRIC
(mm/hr) NDVI
Mismatch
Mismatch: Irrigation timing, aerodynamic and radiometric temperature, zoh, partitioning of the fluxes
Results and discussions ET
ET hourly ET daily
Phase 2 (06/18/2008, before adjustment)
Daily ET is computed letting the extrapolation
model run beyond the satellite overpass time for a
full day without interrupting at a satellite overpass
time
Results and discussions
Daily ET from 05/17/2008 to 06/18/2008
A1: Irrigated agricultural pixel (Landuse: 82, NDVI: 0.71 to 0.83 and fc: 0.86 to 1)
A2: Irrigated agricultural pixel (Landuse 82, NDVI : 0.12 to 0.32 and fc : 0.05 to 0.27)
D1: Desert pixel (Landuse 52, NDVI: 0.2 to 0.17, fc: 0.28)
Phase 2 (before adjustment)
0
2
4
6
8
10
12
136 141 146 151 156 161 166 171
ET(mm/day)
Day of the year
ET_A1 ET_A2 ET_D1 ETr
Follows very well the reference
ET
Results and discussions
Fluxes METRIC
Results
(06/18/2008 11am.)
Simulated Results
(Extrapolation model)
(06/18/2008 11am.)
Simulated Results
(Inversion model)
(06/18/2008 11 am.)
1 2 3 4 5 6 7 8 9 10 11 12 13 14
ET Mean Standard
deviation
Mean Standard
Deviation
R2 Slope Intercept MAE RMSE E di Mean Standard
Deviation
(mm/hr) mm/hr) (mm/hr) (mm/hr) (mm/hr) (mm/hr) (mm/hr)
URA AOI 0.62 0.20 0.62 0.29 0.63 1.17 -0.11 0.13 0.18 0.16 0.67 0.62 0.2
BLA AOI 0.59 0.19 0.54 0.3 0.66 1.2 -0.20 0.15 0.19 0.04 0.66 0.59 0.19
MD AOI 0.16 0.04 0.18 0.04 0.61 0.66 0.7 0.02 0.03 0.44 0.65 0.16 0.05
Temperature
(Tb)
K K K K K
URA AOI 303.1 6.5 302.7 3.17 0.59 0.57 128.4 3.17 4.18 0.59 0.67 302.3 3.8
BLA AOI 304.0 5.8 304.0 4.6 0.52 0.90 28.7 3.2 4.09 0.51 0.65 303.2 3.2
MD AOI 322.1 0.87 309.5 0.54 0.00 -0.04 323.49 12.63 12.67 -206.5 0.05 309.0 0.7
Ground heat
flux
(G)
W/m2 W/m2 W/m2 W/m2 W/m2 W/m2 W/m2
URA AOI 57.3 24.51 39.05 45.8 0.85 1.73 -60.41 28.1 30.9 -0.59 0.58 31.47 35.81
BLA AOI 70.4 44.0 49.68 48.53 0.38 0.56 42.3 34.7 45.3 -0.06 0.53 36.2 34.9
MD AOI 115.2 11.2 75.3 17.9 0.83 1.4 -92.69 39.9 40.8 -12.2 0.19 68.3 19.5
Sensible
heat flux (H)
W/m2 W/m2 W/m2 W/m2 W/m2 W/m2 W/m2
URA AOI 109.4 73.9 159.18 66.5 0.46 1.0 49.62 66.5 93.14 -0.58 0.54 177.62 67.4
BLA AOI 125.6 71.3 198.8 116.8 0.54 0.4 36.3 90.2 108.7 -1.3 0.49 195.6 75.3
MD AOI 288.0 28.1 369.55 8.5 0.24 -0.14 412.56 84.2 87.9 -8.7 0.18 383.84 11.4
Net radiation
(Rn)
W/m2 W/m2 W/m2 W/m2 W/m2 W/m2 W/m2
URA AOI 590.51 49.7 623.2 57.4 0.55 0.85 116.6 43.49 50.95 -0.04 0.56 631.3 46.9
BLA AOI 592.0 45.6 614.36 56.1 0.47 0.56 246.6 37.7 47.0 -0.05 0.57 626.72 40.67
MD AOI 508.7 13.6 568.22 14.17 0.01 -0.1 621.4 59.6 62.9 -20.4 0.15 576.4 15.7
Phase 2 – projected model results vs. METRIC (06/18)
Results and discussions
0
1
2
3
4
50.0
0.2
0.4
0.6
0.8
1.0
1.2
1
31
61
91
121
151
181
211
241
P(mm/3hr)
ET(mm/hr)
Index number (every 3 hours)
P ET_simulated Ess T NDVI
Irrigated agricultural pixel (Landuse: 82, NDVI: 0.71 to 0.83 and fc: 0.86 to 1) from 05/17/2008 to 06/18/2008
0
1
2
3
4
50.0
0.1
0.2
0.3
0.4
0.5
0.6
0.7
0.8
0.9
1
31
61
91
121
151
181
211
241
P(mm/3hr)
ET(mm/hr)
Index number (every 3 hours)
P ET_modeled Ess T NDVI
Irrigated agricultural ET (Landuse 82, NDVI : 0.12 to 0.32 and fc : 0.05 to 0.27) from 05/17/2008 to 06/18/2008
Phase 2 (before adjustment)
Results and discussions
0
80
160
240
1
31
61
91
121
151
181
211
241
Cumulativewater(mm)
Index number (every 3 hours )
Cum_P Cum_ET Cum_Irri
Cum_Dep Cum_ETr
0
80
160
240
1
31
61
91
121
151
181
211
241
Cumulativewater(mm) Index number (every 3 hours )
Cum_P Cum_ET Cum_Irri
Cum_Dep Cum_ETr
A2: Irrigated agricultural pixel (Landuse 82, NDVI: 0.12 to
0.32 and fc: 0.05 to 0.27) from 05/17/2008 to 06/18/2008
A1: Irrigated agricultural pixel (Landuse: 82, NDVI: 0.71 to
0.83 and fc: 0.86 to 1) from 05/17/2008 to 06/18/2008
Phase 2
High cumulative ET and near
reference level
Low cumulative ET compared
to pixel A1

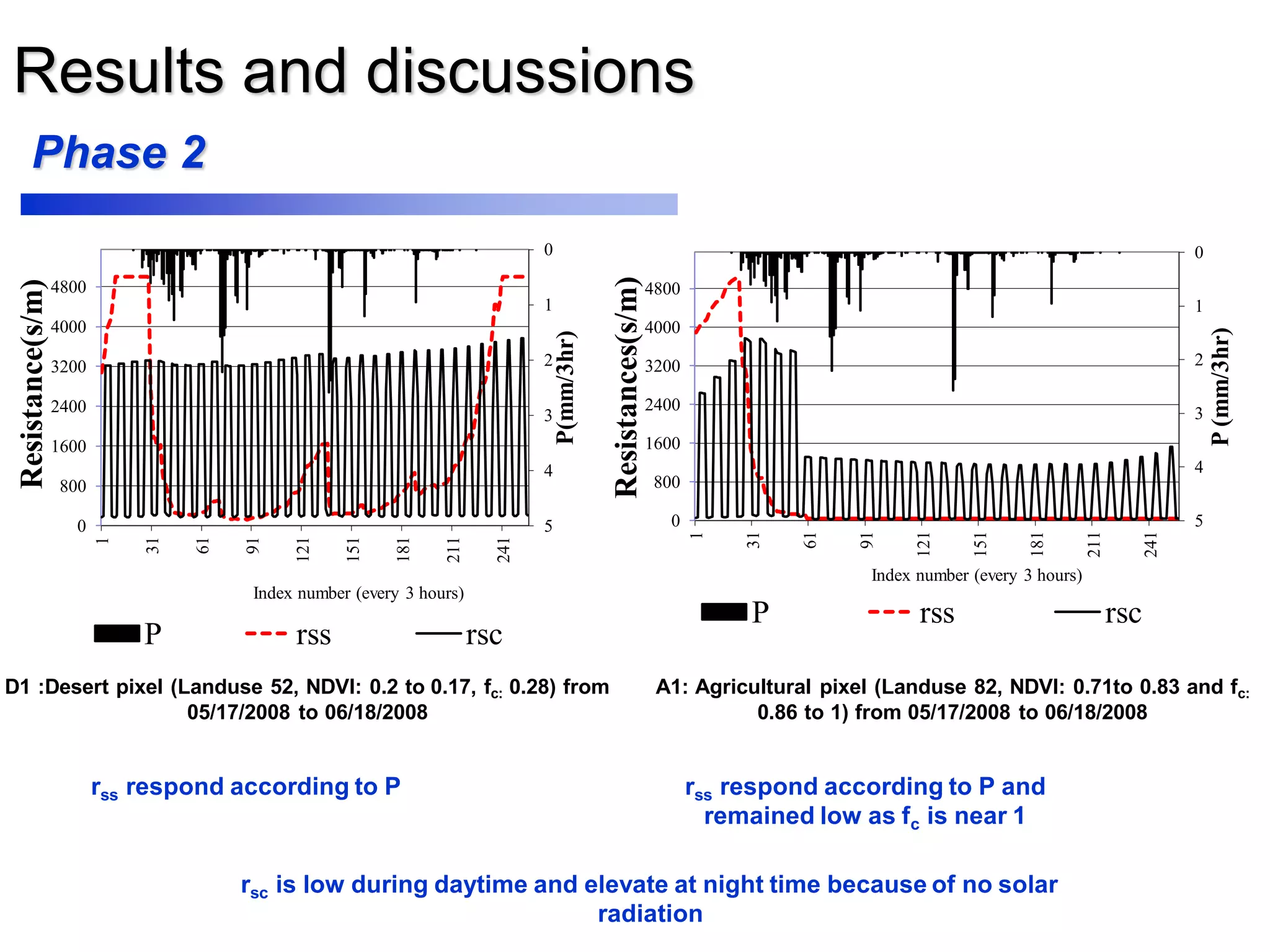

Results and discussions
0
1
2
3
4
50
800
1600
2400
3200
4000
4800
1
31
61
91
121
151
181
211
241
P(mm/3hr)
Resistance(s/m)
Index number (every 3 hours)
P rss rsc
D1 :Desert pixel (Landuse 52, NDVI: 0.2 to 0.17, fc: 0.28) from
05/17/2008 to 06/18/2008
0
1
2
3
4
50
800
1600
2400
3200
4000
4800
1
31
61
91
121
151
181
211
241
P(mm/3hr)
Resistances(s/m)
Index number (every 3 hours)
P rss rsc
A1: Agricultural pixel (Landuse 82, NDVI: 0.71to 0.83 and fc:
0.86 to 1) from 05/17/2008 to 06/18/2008
Phase 2
rss respond according to P rss respond according to P and
remained low as fc is near 1
rsc is low during daytime and elevate at night time because of no solar
radiation

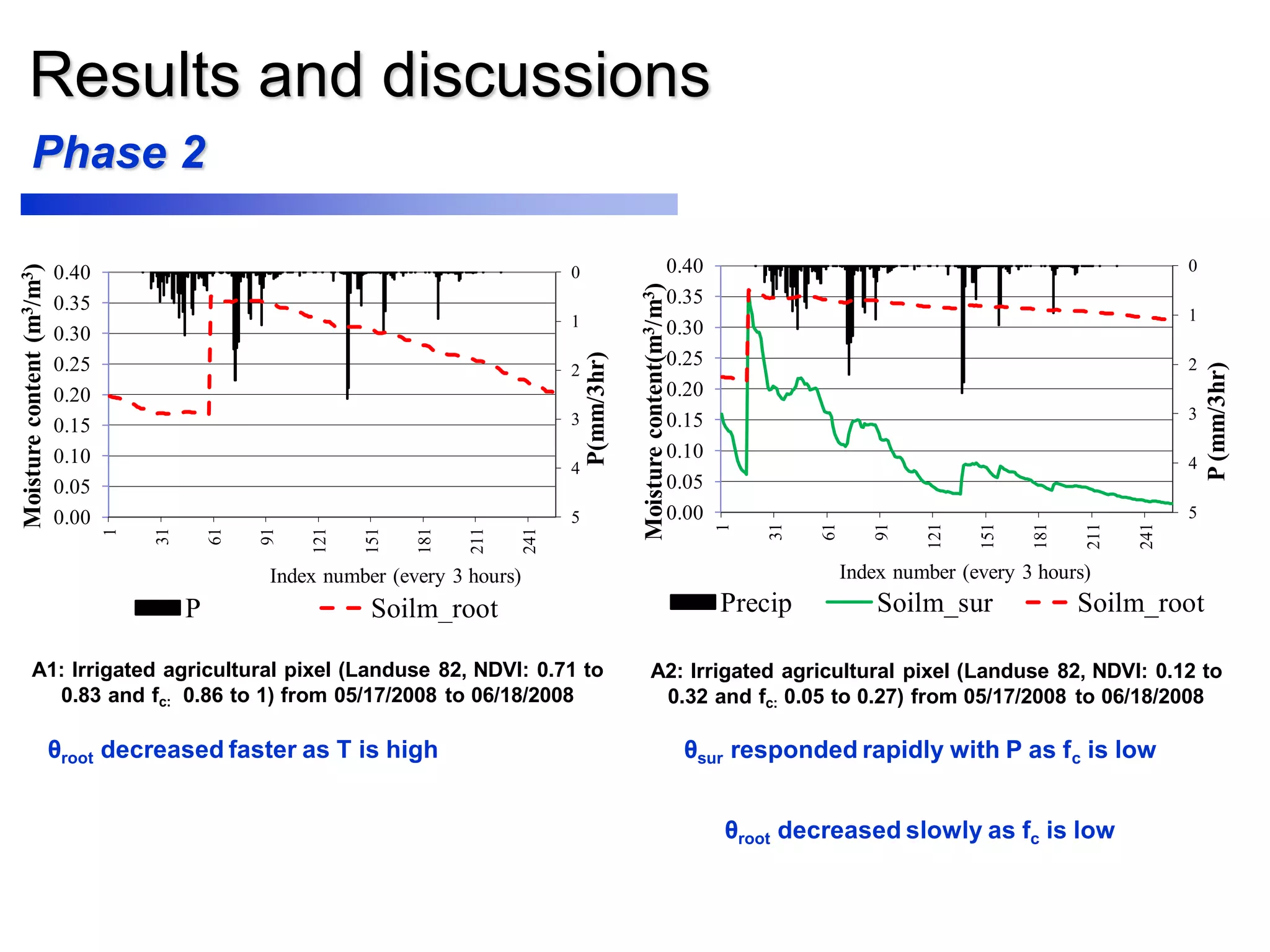

Results and discussions
0
1
2
3
4
50.00
0.05
0.10
0.15
0.20
0.25
0.30
0.35
0.40
1
31
61
91
121
151
181
211
241
P(mm/3hr)
Moisturecontent(m3/m3)
Index number (every 3 hours)
P Soilm_root
A1: Irrigated agricultural pixel (Landuse 82, NDVI: 0.71 to
0.83 and fc: 0.86 to 1) from 05/17/2008 to 06/18/2008
0
1
2
3
4
50.00
0.05
0.10
0.15
0.20
0.25
0.30
0.35
0.40
1
31
61
91
121
151
181
211
241
P(mm/3hr)
Moisturecontent(m3/m3)
Index number (every 3 hours)
Precip Soilm_sur Soilm_root
A2: Irrigated agricultural pixel (Landuse 82, NDVI: 0.12 to
0.32 and fc: 0.05 to 0.27) from 05/17/2008 to 06/18/2008
Phase 2
θroot decreased faster as T is high θsur responded rapidly with P as fc is low
θroot decreased slowly as fc is low
Correction of ET
ETC(i) = ETS(i) − Err
i − i(S)
i(E) − i(S) Error Map 06/18/2008 11am
Phase 3
𝐸𝑟𝑟= 𝐸𝑇𝑠 𝐸 - 𝐸𝑇 𝑀 𝐸ET is adjusted linearly assuming that error grows at the
same rate over the time
Correction of ET
0
1
2
3
4
50.0
0.2
0.4
0.6
0.8
1.0
1.2
1
31
61
91
121
151
181
211
241
P(mm)
ET(mm/hr)
Index number (every 3 hours)
P ET_simulated ET_cor
0
1
2
3
4
50.0
0.2
0.4
0.6
0.8
1
31
61
91
121
151
181
211
241
P(mm)
ET(mm/hr)
Index number (every 3 hours)
P ET_modeled ET_cor
A1: Irrigated agricultural pixel (Landuse: 82, NDVI: 0.71 to 0.83
and fc: 0.86 to 1) from 05/17/2008 to 06/18/2008
A2: Irrigated agricultural pixel (Landuse 82, NDVI: 0.12 to
0.32 and fc: 0.05 to 0.27) from 05/17/2008 to 06/18/2008
Phase 3 ( Adjustment of ET)
Least correction
High correction
Results and discussions
0
0.2
0.4
0.6
0.8
1
1.2
136 141 146 151 156 161 166 171 176
ETrF
Day of the year
ETrF_sim ETrF_METRIC ETrF_cor
A2: Irrigated agricultural pixel (Landuse 82, NDVI: 0.12 to 0.32
and fc: 0.05 to 0.27) from 05/17/2008 to 06/18/2008
Phase 3 (Adjustment of ETrF)
Simulated ETrF is low because of mismatch of Irr
2424 rETF
r
ETET 
Comparison of Hydrus 1D and FAO-56
Paper 3
𝜕θ
𝜕t
=
𝜕
𝜕x
K(h)
𝜕h
𝜕x
+ Cosθ − S
Hydrus-1D - Richards’ Equation
−K h
𝜕h
𝜕x
+ 1 ≤ Emax at z = L
θ is the angle between the flow direction and the
vertical axis (i.e., γ = 00 for vertical flow, 900 for
horizontal flow)
x is the spatial coordinate (positive upward) i.e. x = L at soil
surface and x = 0 at the bottom of the soil profile
h : pressure head
K(h): Unsaturated hydraulic conductivity
Hydrus 1D mode (Šimůnek, 2008)
FAO 56

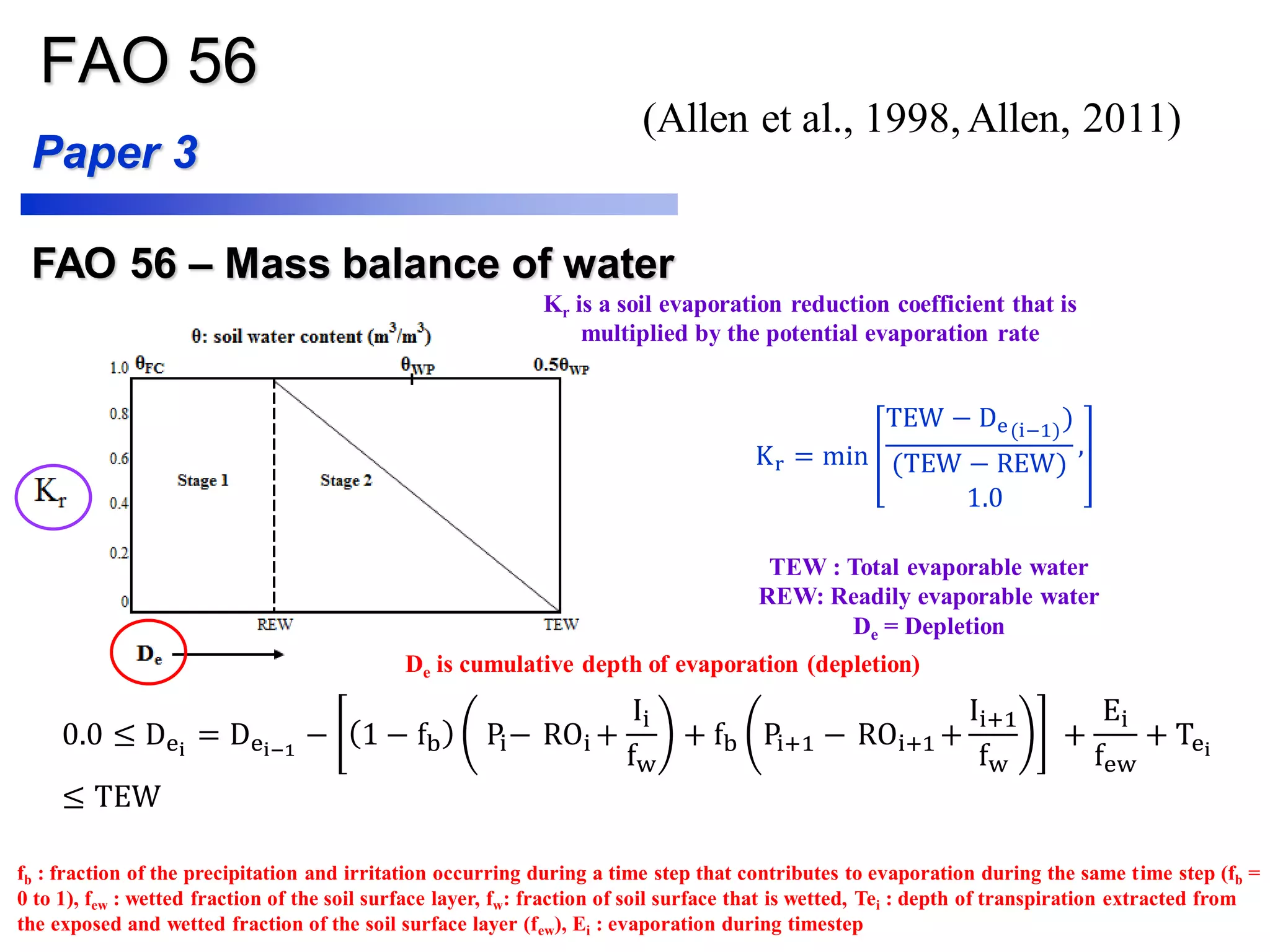

FAO 56 – Mass balance of water
Kr is a soil evaporation reduction coefficient that is
multiplied by the potential evaporation rate
De is cumulative depth of evaporation (depletion)
Paper 3
Kr = min
TEW − De(i−1)
)
(TEW − REW)
,
1.0
0.0 ≤ Dei
= Dei−1
− 1 − fb Pi− ROi +
Ii
fw
+ fb Pi+1 − ROi+1 +
Ii+1
fw
+
Ei
few
+ Tei
≤ TEW
TEW : Total evaporable water
REW: Readily evaporable water
De = Depletion
fb : fraction of the precipitation and irritation occurring during a time step that contributes to evaporation during the same time step (fb =
0 to 1), few : wetted fraction of the soil surface layer, fw: fraction of soil surface that is wetted, Tei : depth of transpiration extracted from
the exposed and wetted fraction of the soil surface layer (few), Ei : evaporation during timestep
(Allen et al., 1998, Allen, 2011)
FAO 56
FAO 56 – Mass balance of water
Stage 1 : Energy limiting stage
Stage 2 : Falling stage
Evaporation is only limited by energy available, no
resistance from soil
Evaporation is limited by soil resistance
ET is in reference level
ET is smaller than reference level
E2 = Kr Ke maxETr
Kemax : potential rate of evaporation relative to the
reference ET
ETr: Reference ET based on alfalfa
E1 = Ke maxETr
Standard input for FAO-56 and Hydrus-1D
Soil Properties Symbol Units Silt Loam
Field Capacity water content θfc m3/m3 0.36
Wilting Point water content θwp m3/m3 0.22
Depth of Surface Soil Layer subjected to Drying by
Evaporation Ze m 0.1
Total Evaporable Water (calculated) TEW mm 25
Readily Evaporable Water REW mm 8
Soil Properties Symbol Units
Sandy
Clay Loam
Silt
Loam
Silt
Residual soil water content θr m3/m3 0.1 0.067 0.034
Saturated soil water content θs m3/m3 0.39 0.45 0.46
Parameter α in the soil water retention
function [L-1]
α
mm-1 0.0059 0.002 0.0016
Parameter n in the soil water retention
function
n
1.48 1.41 1.37
Saturated hydraulic conductivity, Ks [LT-1] Ks mm/day 314.5 108 60
Tortuosity parameter in the conductivity
function
Tr
0.5 0.5 0.5
FAO 56
Hydrus 1D
Paper 3

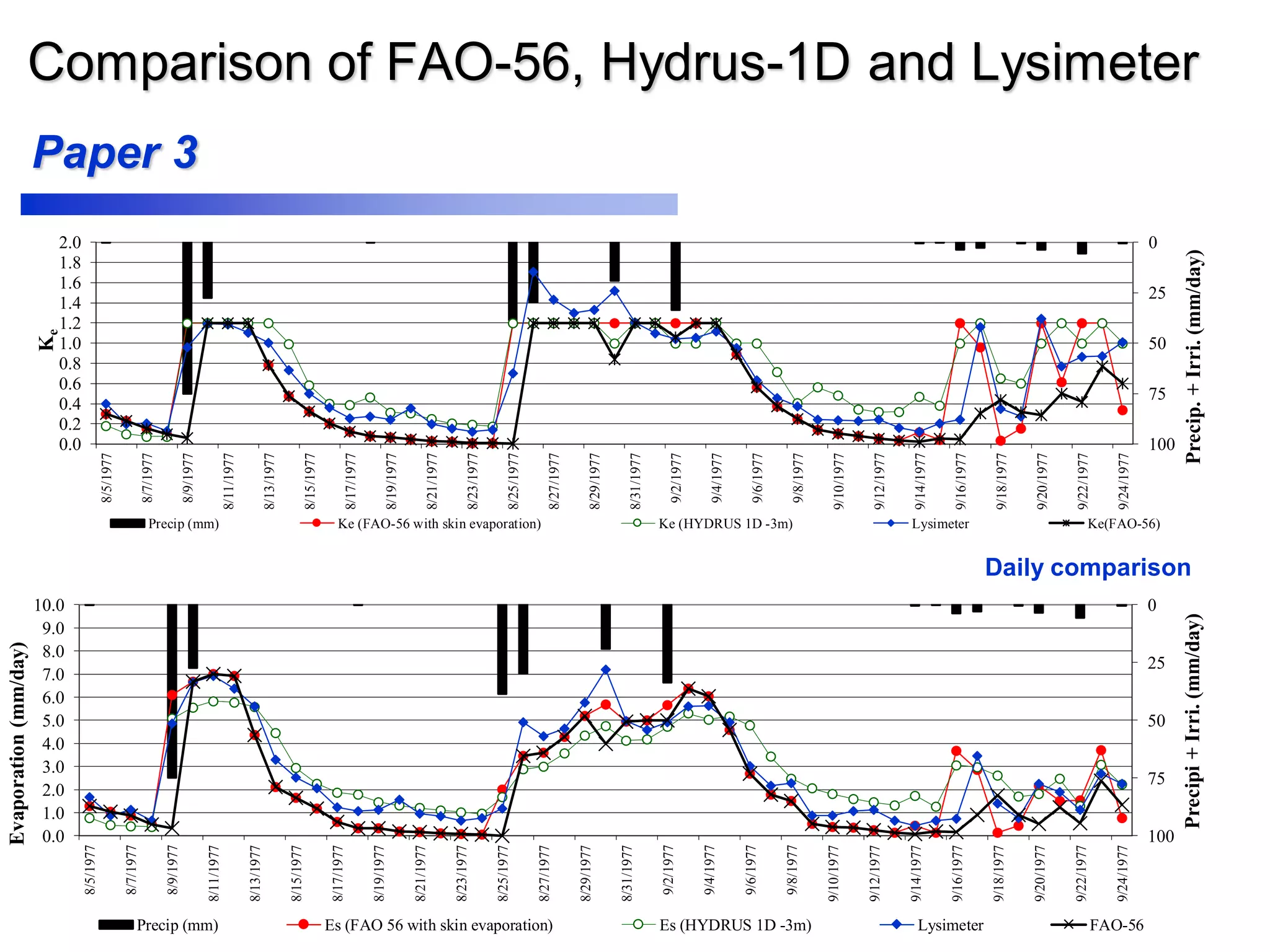

Comparison of FAO-56, Hydrus-1D and Lysimeter
0
25
50
75
1000.0
0.2
0.4
0.6
0.8
1.0
1.2
1.4
1.6
1.8
2.0
8/5/1977
8/7/1977
8/9/1977
8/11/1977
8/13/1977
8/15/1977
8/17/1977
8/19/1977
8/21/1977
8/23/1977
8/25/1977
8/27/1977
8/29/1977
8/31/1977
9/2/1977
9/4/1977
9/6/1977
9/8/1977
9/10/1977
9/12/1977
9/14/1977
9/16/1977
9/18/1977
9/20/1977
9/22/1977
9/24/1977
Precip.+Irri.(mm/day)
Ke
Precip (mm) Ke (FAO-56 with skin evaporation) Ke (HYDRUS 1D -3m) Lysimeter Ke(FAO-56)
0
25
50
75
1000.0
1.0
2.0
3.0
4.0
5.0
6.0
7.0
8.0
9.0
10.0
8/5/1977
8/7/1977
8/9/1977
8/11/1977
8/13/1977
8/15/1977
8/17/1977
8/19/1977
8/21/1977
8/23/1977
8/25/1977
8/27/1977
8/29/1977
8/31/1977
9/2/1977
9/4/1977
9/6/1977
9/8/1977
9/10/1977
9/12/1977
9/14/1977
9/16/1977
9/18/1977
9/20/1977
9/22/1977
9/24/1977
Precipi+Irri.(mm/day)
Evaporation(mm/day)
Precip (mm) Es (FAO 56 with skin evaporation) Es (HYDRUS 1D -3m) Lysimeter FAO-56
Paper 3
Daily comparison
Comparison of Hydrus 1D and FAO-56
0
25
50
75
1000.0
20.0
40.0
60.0
80.0
100.0
120.0
140.0
8/5/1977
8/7/1977
8/9/1977
8/11/1977
8/13/1977
8/15/1977
8/17/1977
8/19/1977
8/21/1977
8/23/1977
8/25/1977
8/27/1977
8/29/1977
8/31/1977
9/2/1977
9/4/1977
9/6/1977
9/8/1977
9/10/1977
9/12/1977
9/14/1977
9/16/1977
9/18/1977
9/20/1977
9/22/1977
9/24/1977
Precip.+Irri.(mm/day)
Cum.ET(mm)
Precip (mm) Ke (FAO 56 with skin evaporation)
Ke (HYDRUS 1D -3m) Lysimeter
y = 0.97x - 0.57
R² = 0.83
0.0
1.0
2.0
3.0
4.0
5.0
6.0
7.0
8.0
0.0 1.0 2.0 3.0 4.0 5.0 6.0 7.0 8.0
Evaporation(mm)FAO56
Evaporation (mm) Lysimeter
y = 1.03x - 0.38
R² = 0.88
0.0
1.0
2.0
3.0
4.0
5.0
6.0
7.0
8.0
0.0 1.0 2.0 3.0 4.0 5.0 6.0 7.0 8.0
Evaporation(mm)FAO56-
skin
Evaporation (mm) Lysimeter
Paper 3
Daily comparison
0
5
10
15
200.0
0.2
0.4
0.6
0.8
1.0
1.2
Precipitation(mm/day)
Ker
Precip (mm) FAO 56 HYDRUS 1D -0.5m
0
5
10
15
200.0
0.2
0.4
0.6
0.8
1.0
1.2
1/1/2002
1/16/2002
1/31/2002
2/15/2002
3/2/2002
3/17/2002
4/1/2002
4/16/2002
5/1/2002
5/16/2002
5/31/2002
6/15/2002
6/30/2002
7/15/2002
7/30/2002
8/14/2002
8/29/2002
9/13/2002
9/28/2002
10/13/2002
10/28/2002
11/12/2002
11/27/2002
12/12/2002
12/27/2002
Precipitation(mm/day)
Ker
Precip (mm) FAO 56 - skin HYDRUS 1D -0.5m

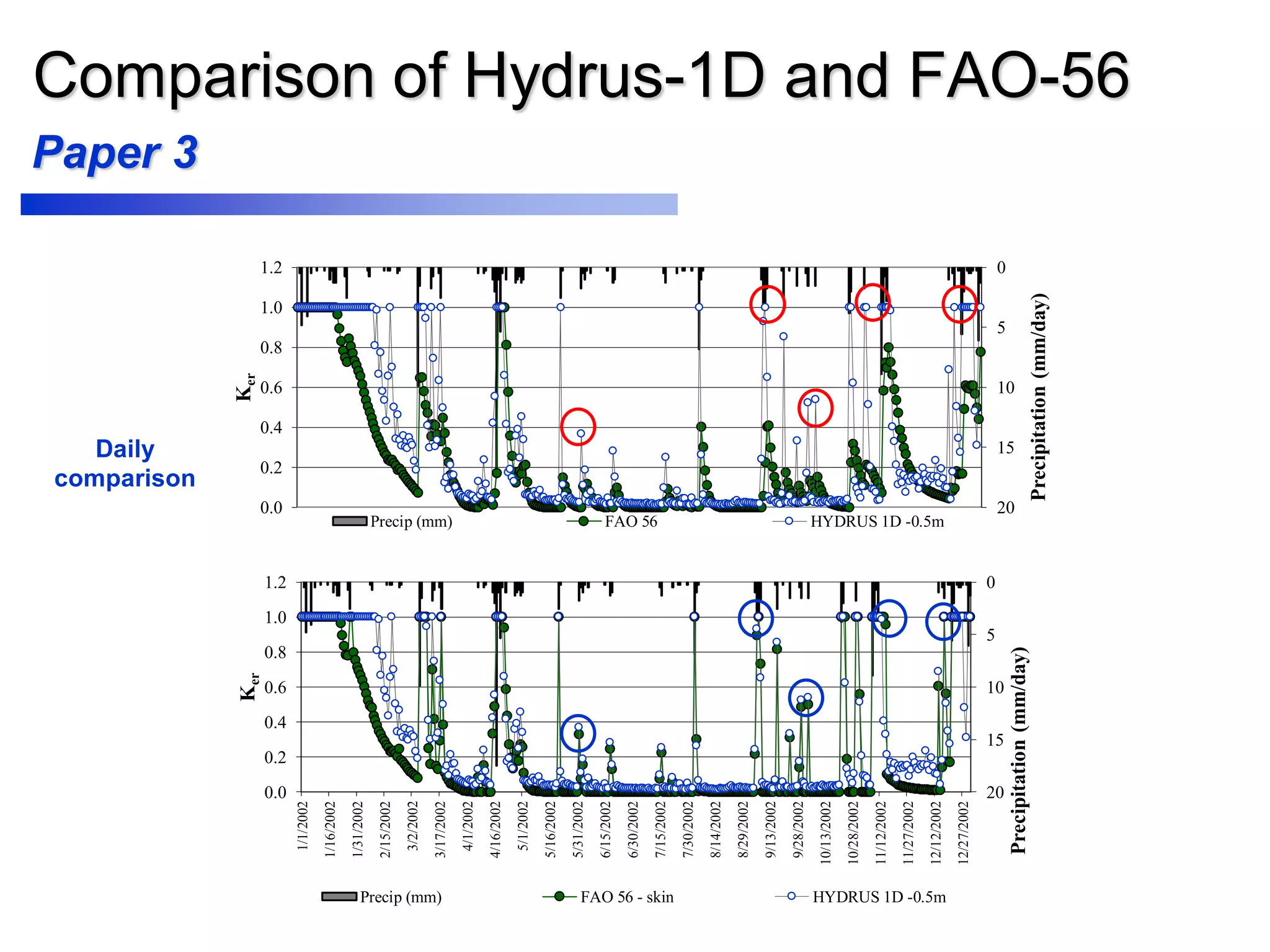

Comparison of Hydrus-1D and FAO-56
Paper 3
Daily
comparison
0
5
10
15
200.0
0.2
0.4
0.6
0.8
1.0
1.2
Precipitation(mm)
Ker
Precip (mm) FAO 56 - skin HYDRUS 1D -3.0m
0
5
10
15
200.0
1.0
2.0
3.0
4.0
5.0
6.0
7.0
1/1/2002
1/16/2002
1/31/2002
2/15/2002
3/2/2002
3/17/2002
4/1/2002
4/16/2002
5/1/2002
5/16/2002
5/31/2002
6/15/2002
6/30/2002
7/15/2002
7/30/2002
8/14/2002
8/29/2002
9/13/2002
9/28/2002
10/13/2002
10/28/2002
11/12/2002
11/27/2002
12/12/2002
12/27/2002
Precipitation(mm/day)
Evaporation(mm/day)
Precip (mm) FAO 56 - skin HYDRUS 1D -3.0m
Comparison of Hydrus-1D and FAO-56
0
5
10
15
200.0
50.0
100.0
150.0
200.0
250.0
300.0
1/1/2002
1/16/2002
1/31/2002
2/15/2002
3/2/2002
3/17/2002
4/1/2002
4/16/2002
5/1/2002
5/16/2002
5/31/2002
6/15/2002
6/30/2002
7/15/2002
7/30/2002
8/14/2002
8/29/2002
9/13/2002
9/28/2002
10/13/2002
10/28/2002
11/12/2002
11/27/2002
12/12/2002
12/27/2002
Precipitation(mm/day)
Cum.Evap.(mm)
Precip (mm) FAO 56 - skin HYDRUS 1D -3m
y = 1.08x - 0.06
R² = 0.88
0.0
1.0
2.0
3.0
4.0
5.0
6.0
7.0
0.0 1.0 2.0 3.0 4.0 5.0 6.0 7.0
Evaporation(mm)FAO56
Evaporation (mm) HYDRUS 1D
Paper 3
Daily comparison

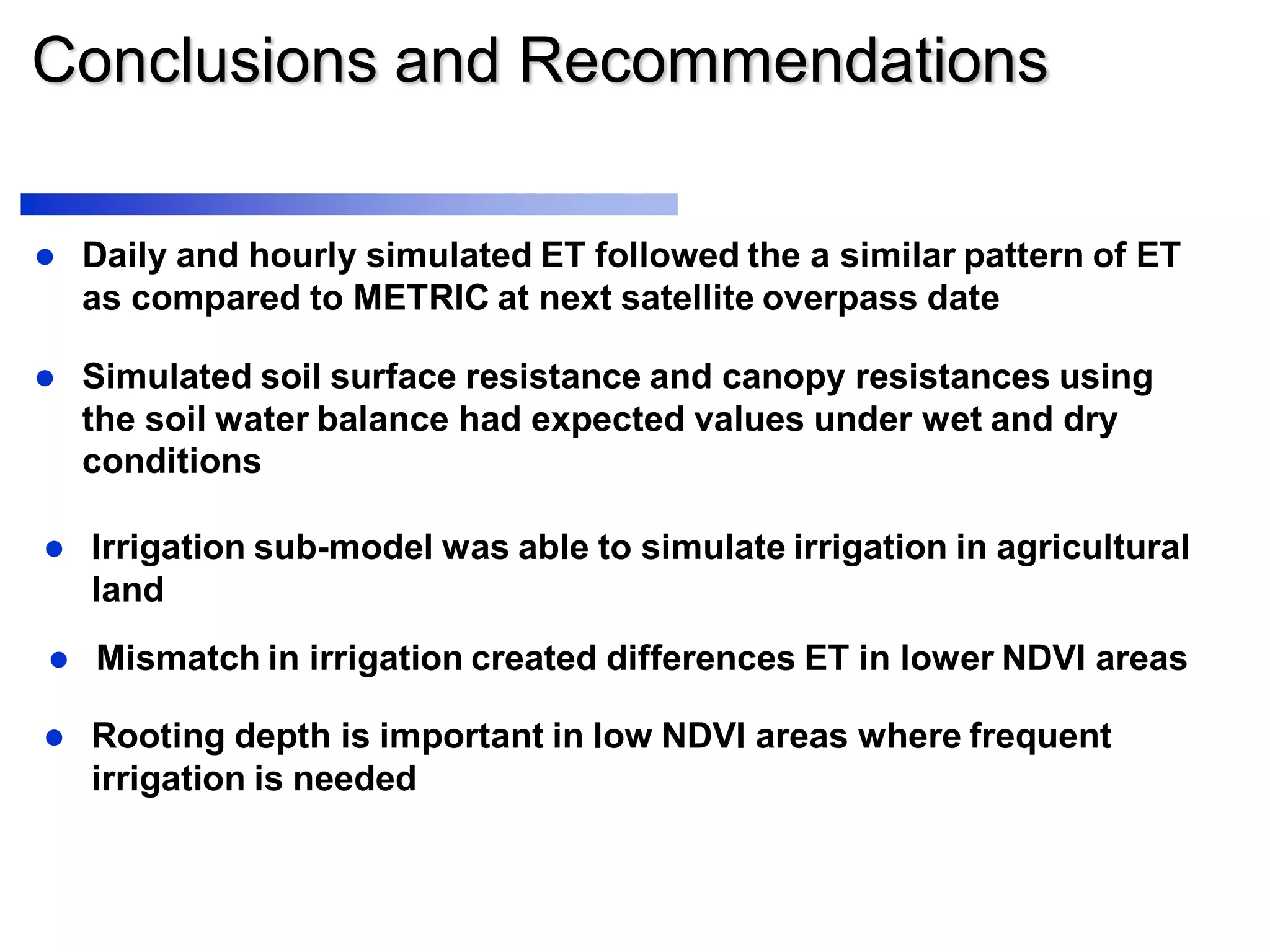

Conclusions and Recommendations
 Model was able to simulate reasonable values of surface energy
fluxes
 Simulation of ET between the satellite overpass dates without the
thermal band based surface temperature was challenging
 Model was able to simulate reasonable values of surface
temperatures inside surface energy balance
 NARR reanalysis data and METRIC data was able compute surface
energy balance in between the satellite overpass dates
 Difference in simulated and METRIC surface temperature create
some differences in fluxes

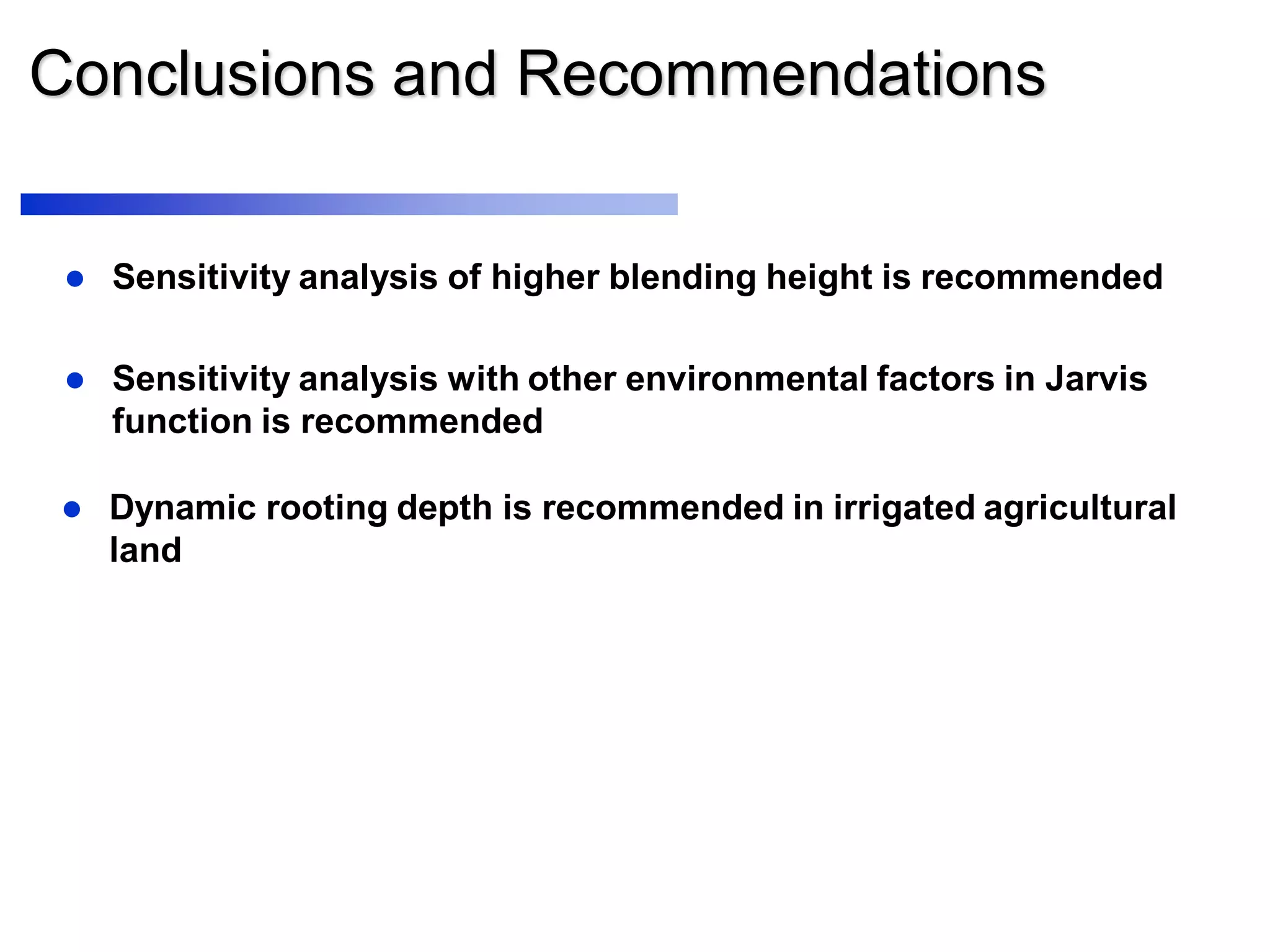

Conclusions and Recommendations
 Daily and hourly simulated ET followed the a similar pattern of ET
as compared to METRIC at next satellite overpass date
 Simulated soil surface resistance and canopy resistances using
the soil water balance had expected values under wet and dry
conditions
 Irrigation sub-model was able to simulate irrigation in agricultural
land
 Mismatch in irrigation created differences ET in lower NDVI areas
 Rooting depth is important in low NDVI areas where frequent
irrigation is needed
Conclusions and Recommendations
 FAO-56 model was able to simulate similar soil water balance and
evaporation compared to Hydrus 1D model and Lysimeter data
 Computations of fluxes using two source model generated massive
amount of data
 Convergence process was difficult in extremely low wind speed
and very small solar radiation etc.
 Simulation of ET for every three hours required substantial
computer time and was computationally intensive using DELL multi-
core 64-bit Windows-based work station
 Enhanced FAO-56 model was able capture small precipitation
events when compared to advanced Hydrus 1D model
 Sensitivity analysis of higher blending height is recommended
 Sensitivity analysis with other environmental factors in Jarvis
function is recommended
Conclusions and Recommendations
 Dynamic rooting depth is recommended in irrigated agricultural
land
Thank you for your time!!!!

Time integration of evapotranspiration using a two source surface energy balance model using NARR reanalysis weather data and satellite based METRIC data

  • 1.
  • 2.
    Time integration ofevapotranspiration using a two source surface energy balance model using NARR reanalysis weather and satellite based METRIC data Ramesh Dhungel Major professor: Dr. Richard G. Allen Committee Members: Dr. Fritz Fiedler, Dr. Karen Humes, Dr. Ricardo Trezza Department of Civil Engineering University of Idaho Developed methodologies and models Dissertation defense
  • 3.
    Outline  Background andMotivation  Problem statement  Objectives  Results and discussions  Methodology  Study Area  Conclusions and Recommendations
  • 4.
    Background and motivation Need of high spatial and temporal resolution ET maps  Availability of weather based gridded data to complete and close surface energy balance  Need of ET in between the satellite overpass dates  Unavailability of thermal based surface temperature and satellite images for computing ET in-between the satellite overpass dates  Need of accurate ET for water rights issues, groundwater recharge, irrigation management, crop water management etc.
  • 5.
    Problem statement 1. Landsatsatellite only overpass the same area once each 4-8 days, only at about 11:am 2. Remote sensing models are able to compute relatively accurate ET at 4-8 days 5. Problem with image timing. Precipitation event prior to the satellite overpass can elevate the ET values so the image may not represent the period, for example a month. 3. But the major problem is the cloudy images and these images can’t be used to compute ET 4. Because of the clouds, computation of ET from satellite images can be longer than a month
  • 6.
    Problem statement 6. Challengeremains to extrapolate ET between the satellite overpass dates 7. Currently, ET is extrapolated using splined interpolation of ETrF r ET ins ET FETr  Reference ET from Meteorological station HGRET nins  Rn G H Satellite based ET Relative ETrF can be interpolated or extrapolated over intervening time periods between satellite overpasses
  • 7.
    Objectives Specific Objectives 1. Developprocedures to apply currently available gridded data to compute ET during the extrapolating period 3. Compare the simple FAO 56 soil water balance model to a more advanced Hydrus 1D soil water balance model 2. Develop a resistance based two source surface energy balance model that incorporates soil water balance model Extrapolation of ET between satellite overpass dates Main Objective
  • 8.
    Objectives Specific Objectives 4. Developa procedure to expedite the numerical iteration process used in the surface energy balance 6. Develop a computational strategy to force simulated ET to adequately target METRIC ET for next satellite overpass date 5. Develop a irrigation sub-model to incorporate the impacts of irrigation events of ET form agricultural areas
  • 9.
    Methodology Three phases Phase 1-Inversion of METRIC ET from NARR reanalysis data and METRIC data Phase 3- Adjustment of of ET to agree with the next METRIC image Phase 2- Extrapolation of ET from NARR reanalysis data and METRIC roughness data
  • 10.
    Phase 1,2,3 Papers Paper 3 Comparisonsbetween the FAO-56 soil water evaporation model and HYDRUS 1D evaporation model over a range of soil textures Paper 1 – Phase 1 Parameterization of soil moisture and vegetation characteristics with a two source surface energy balance model using NARR and METRIC data sets at satellite overpass time Paper 2 – Phase 2 and 3 Extrapolation of ET with a two source surface energy balance model using NARR reanalysis weather data and Landsat-based METRIC ET data
  • 11.
    Completion of study Literature Review  Exploration of current available ET models and procedures (Single and multiple sources) – SEBAL (Bastiaanssen et al., 1998) – SEBS (Su, 2002) – ALEXI (Norman et al., 2003) – METRIC (Allen et al., 2007) – Raupach, 1989 – McNaughton and Van den Hurk, 1995 – Shuttleworth and Wallace, 1985 – Choudhury and Monteith, 1988 – Norman et al., 1995 – Li et al. 2005 – Colaizzi et al., 2012 etc.  Development of a land surface model  Testing the model  Development of code
  • 12.
    Time schedule Year WorkDone Remarks 1 Course work and research ( 2009 – 2010) • Course work • Gathered ideas for the dissertations • Gathered data and finalization of procedure Kimberly first semester, Moscow Campus second semester 2 Course work and research (2010 – 2011) • Course work • Worked on comparison on Hydrus-1D to FAO- 56 model • Worked on accuracy of the equations on METRIC model • Understood the ET computation procedure from METRIC • Processed METRIC images for generating data Kimberly 3 Course work and Development of procedure ( 2011 – 2012) • Course work • Understood the currently available models • Developed a model to extract NARR reanalysis data • Developed different procedures of land surface model starting with a single source model • Understood the possibility of using Penman Monteith equation and aerodynamic equation • Develop a simple two source model for testing purpose Kimberly 4 Development of model (2012-2013) • Developed a detail two source model • Incorporated soil water balance components • Developed irrigation scheduling model, code the model Kimberly 5 Running and testing (2013 – 2014) • Developed the ET adjustment model • Run the model for accuracy analysis • Wrote papers • Defend the work Kimberly
  • 13.
    Study area anddata NARR reanalysis data METRIC data - At satellite overpass Single pixel = 1024 km2 32 km resolution, every 3 hours 29 pressure level and surface level data UTC time zone, Lambert conformal conic projection Grib (Grided binary and netcdf (network common data form) format Southern Idaho near American Falls Study area near American Falls, ID overlaying Idaho map, Landsat image and NARR pixel for May 17, 2008 30m resolution of all bands 60m-120m resolution of thermal band
  • 14.
    Data uz(m/s), Ta(K), qa(kg/kg)Blending height 30m RS↓(W/m2) RL↓(W/m2) P(mm/3hr) Srun(mm/3hr) α LAI, NDVI εo Zom(m) NARR reanalysis METRIC Data
  • 15.
    NARR reanalysis relook Studyarea near American Falls, ID overlaying Idaho map and NARR downward longwave radiation for north America for May 17, 2008 North American Regional Reanalysis
  • 16.
    Developed Land Surfacemodel Wind Speed, Air Temperature, Specific Humidity Blending Height 30m Incoming Solar Radiation Incoming Longwave Radiation Outgoing Longwave Radiation from Soil Outgoing Longwave Radiation from Vegetation Soil Evaporation Canopy transpiration Root Zone Soil Moisture Soil Surface Soil Moisture Precipitation Sensible Heat Flux from Soil Sensible Heat Flux from Vegetation Surface Runoff Drainage to Root Zone Layer Deep Percolation from Root Zone Layer Irrigation Overall process – Paper 1 and paper 2 (Phase 1,2,3)
  • 17.
    Developed two sourcemodel  Inversion model 1: Computes the canopy transpiration, soil moisture at root zone and canopy resistance for the satellite overpass date  Inversion model 2: Computes the soil evaporation, soil moisture at surface and soil surface resistance for the satellite overpass date  Extrapolation model 3: Extraplates ET between the satellite overpasses dates in conjunction with irrigation and soil water balance using a three-hour timesteps  Adjustment model 4: Adjusts the extrapolated ET between the satellite overpass dates over all timesteps The major four models are listed below:  Python and ArcGis Script  About 10 thousand lines code
  • 18.
    Model description  Usesunique and accurately calibrated METRIC ET to partition ET at the start of the simulation and to adjust simulated ET  Uses resistance based aerodynamic surface energy balance approach to fluxes  Not dependent on the thermal sensor based surface temperature to extrapolate ET in the intervening time period  Uses less meteorological data from the weather station  Uses currently available gridded weather data to compute ET for higher temporal resolution i.e. 3 hours  Developed as an improvement and simplification of current available models
  • 19.
  • 20.
    Running the code andOutput An example
  • 21.
    Output variables andfluxes 0 1 2 3 4 5 6 7 8 9 10 i Date precip ssrun irrigation NDVI fc hc d n Zom Index MDH-UTM mm/3hr mm/3hr m3/m3 - - m m - m 11 12 13 14 15 16 17 18 19 20 Z1 rac LAI In_short In_long Tair uz S_hum Albedo Albedo_soil m s/m - W/m2 W/m2 K m/s kg/kg - - 21 22 23 24 25 26 27 28 29 30 Albedo_veg ea eosur Air_den u_fri rss kh ras_bare ras_full ras - kPa kPa kg/m3 m/s s/m - s/m s/m s/m 31 32 33 34 35 36 37 38 39 40 rsc_final rah soilm_cur_final H_Flux_rep_soi l Ts outlwr_soil LE_soil Lambda_soil ETsoi_sec_pre ETsoil_hour s/m s/m m3/m3 W/m2 K W/m2 W/m2 J/kg mm/sec mm/hr 41 42 43 44 45 46 47 48 49 50 G_Flux_ite_soil sheat_soil_final soilm_root_final H_Flux_rep_veg Tc outlwr_veg eoveg f F1 AWF W/m2 W/m2 m3/m3 W/m2 K W/m2 kPa - - - 51 52 53 54 55 56 57 58 59 60 F4 ETveg_sec_pr e ETveg_hour LE_veg sheat_veg_final netrad_veg netrad_soil T_com netrad sheat - mm/sec mm/hr W/m2 W/m2 W/m2 W/m2 K W/m2 W/m2 61 62 63 64 65 66 67 68 69 70 gheat_com LE EThour_co m Ref_ET Pevap X_30m psi_m_30m psi_h_30m X_dzom psi_h_dzom W/m2 W/m2 mm/hr mm/sec mm/3hr - - - - - 71 72 73 74 X_hd psi_h_hd L stat_img - - m - About 100 parameters, variables and fluxes
  • 22.
    Variables and fluxes used in models Fluxes,Parameters and boundary conditions Symbol Min Max Units Sensible heat flux H -50 500 W/m2 Sensible heat flux for soil portion Hs -50 500 W/m2 Sensible heat flux for canopy portion Hc -50 500 W/m2 Ground heat flux G -50 200 W/m2 Latent heat flux for soil (LEs) - - W/m2 Latent heat flux for canopy (LEc) - - W/m2 Incoming shortwave radiation Rs↓ - - W/m2 Incoming longwave radiation RL↓ - W/m2 Friction velocity u* 0.01 500 m/s Aerodynamic resistance from canopy height to blending height rah 1 500 s/m Albedo soil αs 0.15 0.28 - Albedo canopy αc 0.15 0.24 Single area leaf equivalent bulk stomatal resistance rl 80 5000 s/m Fraction of cover fc 0.05 1 - Roughness length of momentum Zom 0.01 m Bulk boundary layer resistance of the vegetative elements in the canopy rac 0 5000 s/m Canopy resistance rsc 0 5000 s/m Soil surface resistance rss 35 5000 s/m Single area leaf equivalent bulk stomatal resistance rl 80 5000 s/m
  • 23.
    Land surface model Latentheat flux (LE ) model-the players a p s a s ah ss as C e e LE r r r           WindTemperature a p c a c ah sc ac C e e LE r r r           Aerodynamic eqn. of LE es: saturation vapor at soil surface, d is zero plane displacement, zos : minimum value of roughness length, cp : specific heat capacity of moist air , γ : psychrometric constant, ρa : atmospheric density, fc : fraction of canopy cover 𝒇 𝐜 = 𝑵𝑫𝑽𝑰 − 𝑵𝑫𝑽𝑰 𝒎𝒊𝒏 𝑵𝑫𝑽𝑰 𝒎𝒂𝒙 − 𝑵𝑫𝑽𝑰 𝒎𝒊𝒏
  • 24.
    Land Surface model Sensibleheat flux (H) model - the players ( )a p s a s ah as C T T H r r     ( )a p c a c ah ac C T T H r r     Temperature Wind Aerodynamic eqn. of H
  • 25.

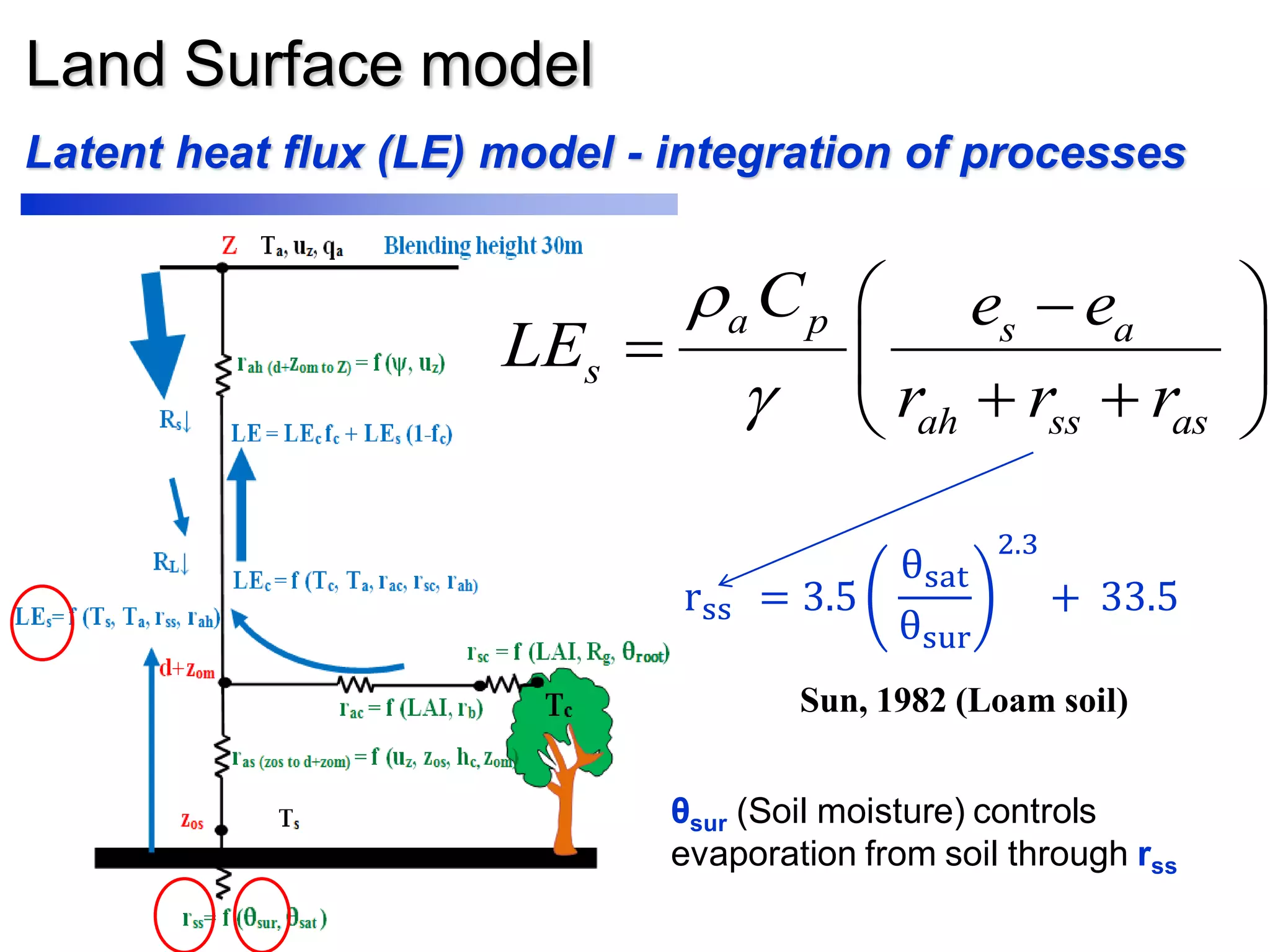

    Land Surface model Latentheat flux (LE) model - integration of processes rss = 3.5 θsat θsur 2.3 + 33.5 θsur (Soil moisture) controls evaporation from soil through rss a p s a s ah ss as C e e LE r r r           Sun, 1982 (Loam soil)
  • 26.
    Land surface model Latentheat flux (LE) model - integration of processes a p c a c ah sc ac C e e LE r r r           rsc = rl LAI fc F1 F4 AWF = θroot − θwp θfc − θwp F4 = 1 1 + 20 e(−8 AWF) θroot (Soil moisture at root) controls transpiration from soil through rsc
  • 27.

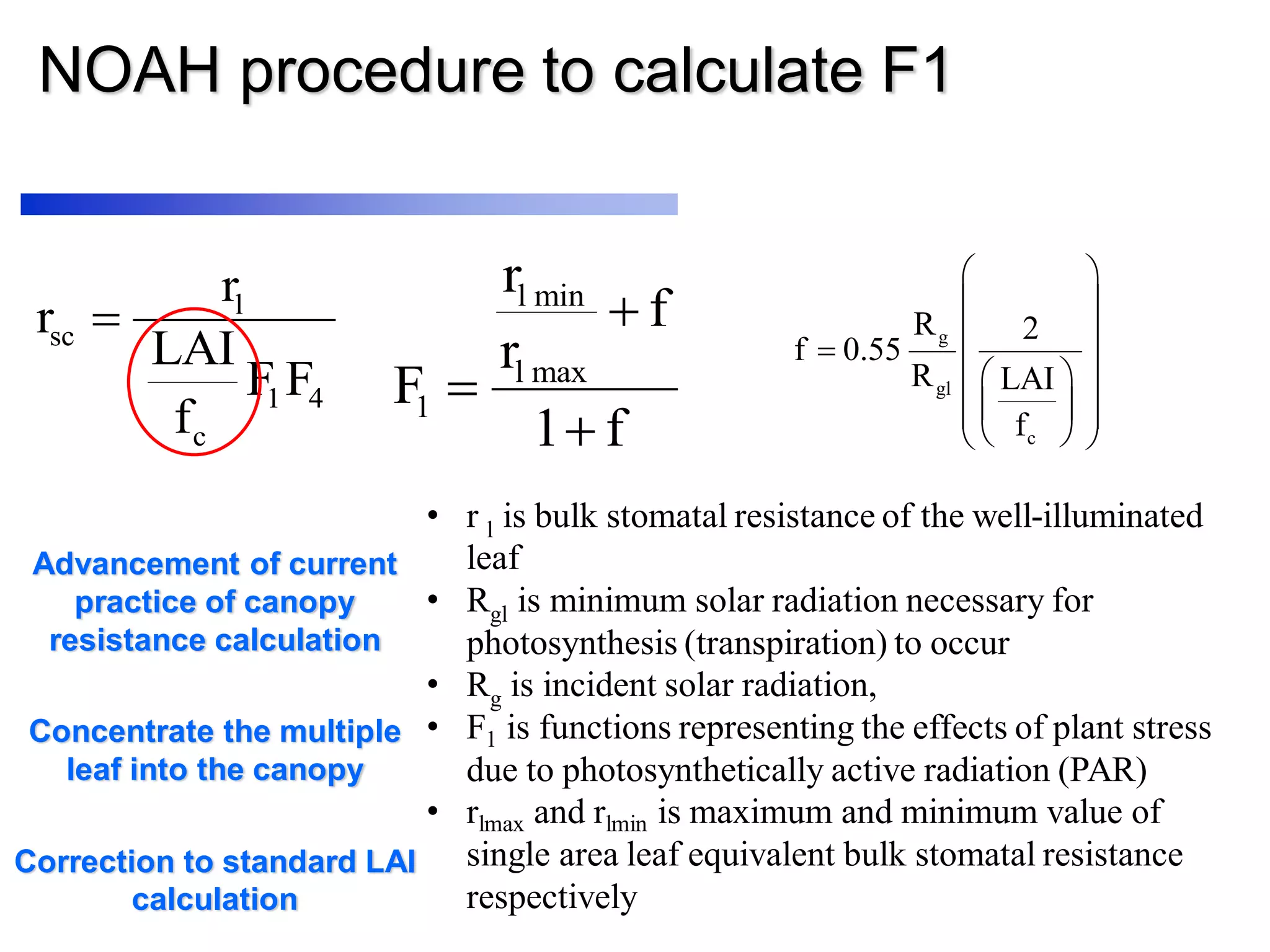

    NOAH procedure tocalculate F1 l min l max 1 r f r F 1 f    g gl c R 2 f 0.55 R LAI f                 • r l is bulk stomatal resistance of the well-illuminated leaf • Rgl is minimum solar radiation necessary for photosynthesis (transpiration) to occur • Rg is incident solar radiation, • F1 is functions representing the effects of plant stress due to photosynthetically active radiation (PAR) • rlmax and rlmin is maximum and minimum value of single area leaf equivalent bulk stomatal resistance respectively l sc 1 4 c r r LAI F F f  Advancement of current practice of canopy resistance calculation Concentrate the multiple leaf into the canopy Correction to standard LAI calculation
  • 28.

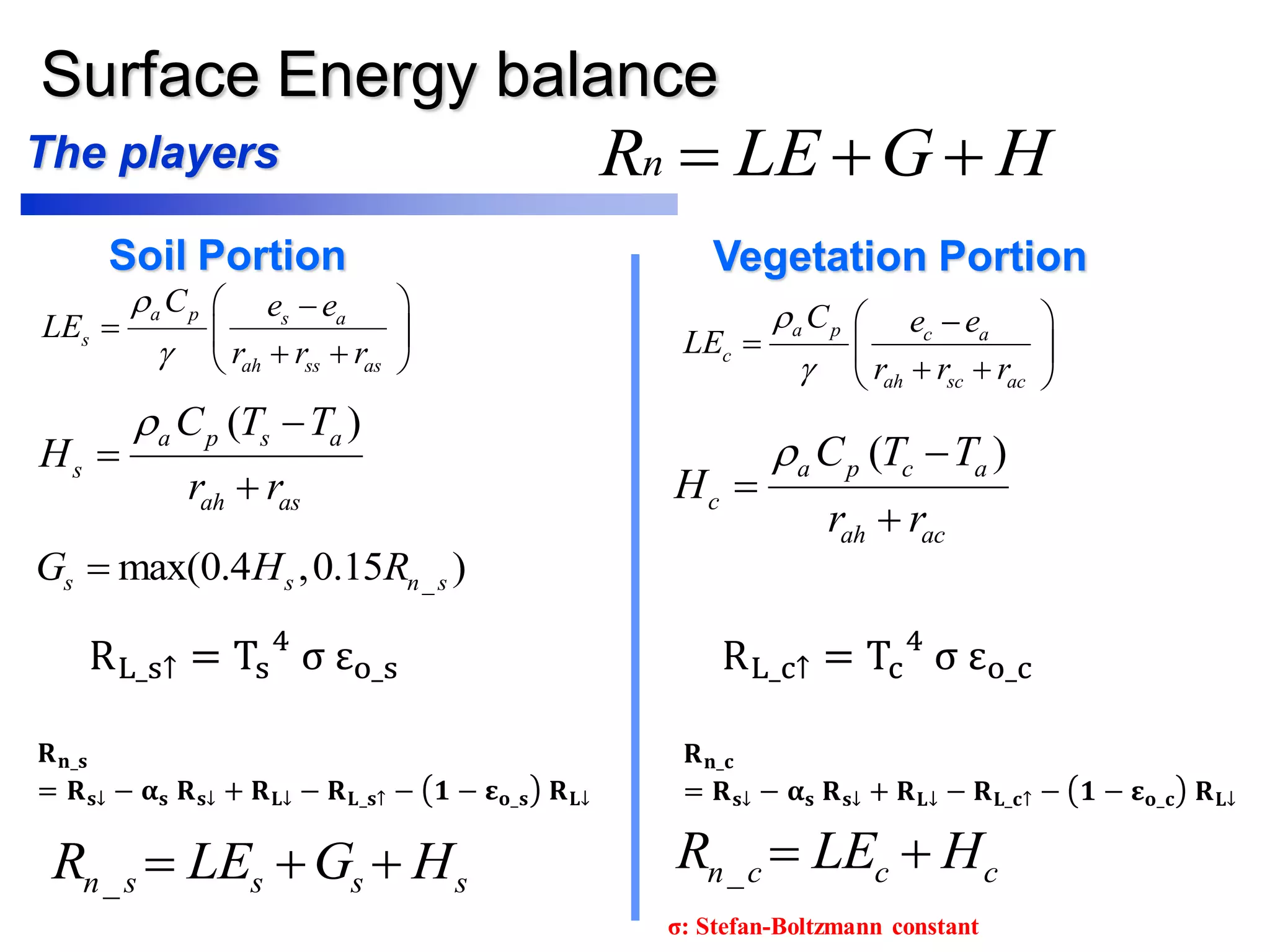

    Surface Energy balance SoilPortion Vegetation Portion _n s s s sR LE G H   _n c c cR LE H  _max(0.4 ,0.15 )s s n sG H R ( )a p s a s ah as C T T H r r     ( )a p c a c ah ac C T T H r r     a p s a s ah ss as C e e LE r r r           a p c a c ah sc ac C e e LE r r r           HGLERn The players 𝐑 𝐧_𝐬 = 𝐑 𝐬↓ − 𝛂 𝐬 𝐑 𝐬↓ + 𝐑 𝐋↓ − 𝐑 𝐋_𝐬↑ − 𝟏 − 𝛆 𝐨_𝐬 𝐑 𝐋↓ RL_s↑ = Ts 4 σ εo_s 𝐑 𝐧_𝐜 = 𝐑 𝐬↓ − 𝛂 𝐬 𝐑 𝐬↓ + 𝐑 𝐋↓ − 𝐑 𝐋_𝐜↑ − 𝟏 − 𝛆 𝐨_𝐜 𝐑 𝐋↓ RL_c↑ = Tc 4 σ εo_c σ: Stefan-Boltzmann constant
  • 29.
    Iteration procedure of rah(Phase 1) Backward averaged H, G, u* Initial H is taken from METRIC in Phase 1 Two source surface energy balance model Computed soil and canopy portion fluxes separately METRIC ET Convergence of rah makes convergence of surface energy balance fluxes
  • 30.
    Iteration procedure of rah(Phase 2) No METRIC ET Initial H is taken from previous timesteps in Phase 2
  • 31.
    Inputs from METRICModel ETins(mm/hr) NDVI fc 05/17/2008Phase 1
  • 32.

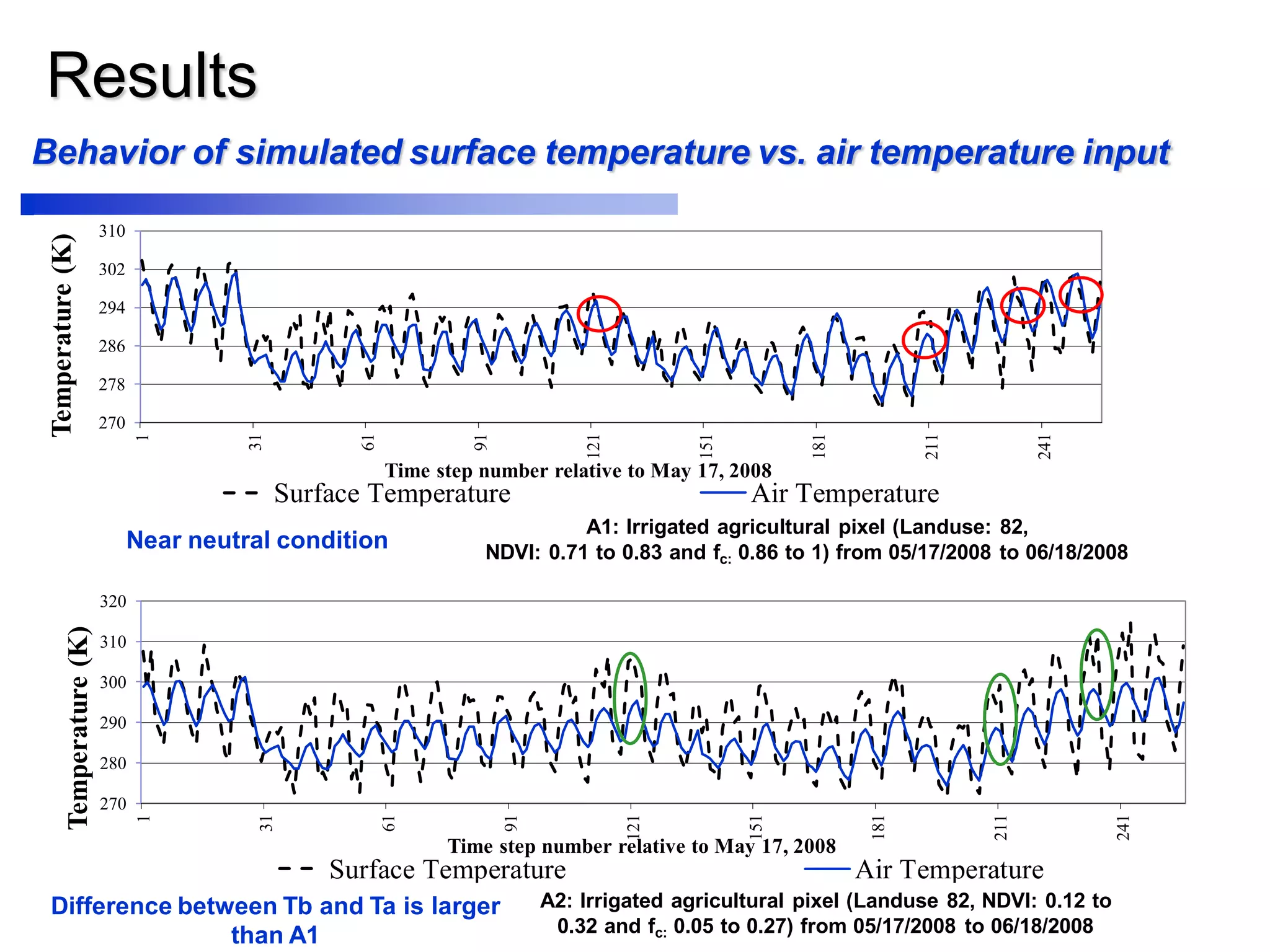

    270 278 286 294 302 310 1 31 61 91 121 151 181 211 241 Temperature(K) Time step numberrelative to May 17, 2008 Surface Temperature Air Temperature 270 280 290 300 310 320 1 31 61 91 121 151 181 211 241 Temperature(K) Time step number relative to May 17, 2008 Surface Temperature Air Temperature Results A1: Irrigated agricultural pixel (Landuse: 82, NDVI: 0.71 to 0.83 and fc: 0.86 to 1) from 05/17/2008 to 06/18/2008 A2: Irrigated agricultural pixel (Landuse 82, NDVI: 0.12 to 0.32 and fc: 0.05 to 0.27) from 05/17/2008 to 06/18/2008 Behavior of simulated surface temperature vs. air temperature input Near neutral condition Difference between Tb and Ta is larger than A1
  • 33.
    Models Coordinates (m) NLCD Landuse classes fc Tb (K) H (W/m2) G (W/m2) Rn (W/m2) LE (W/m2) METRIC2612097, 1330202 Agricultural 0.063 305 119 96 641 426 Simulated 303 92 84 603 427 METRIC 2606520, 1327977 Desert 0.28 321 278 111 519 130 Simulated 309 334 78 543 131 METRIC 2604335, 1326667 Grassland 0.19 324 275 110 499 114 Simulated 310 316 93 525 116 METRIC 2600245, 1328521 Agricultural 0.85 301 98 43 600 459 Simulated 303 138 12 609 459 METRIC 2609171, 1333273 Agricultural 0.05 320 250 100 445 95 Simulated 313 284 105 485 96 METRIC 2612312, 1329483 Agricultural 0.24 309 155 90 603 358 Simulated 305 160 64 583 359 Results and discussions Surface energy fluxes for different landuse classes
  • 34.
    Results and discussions 30thousand pixels Two different dates 05/17/2008 and 06/18/2008 Phase 1 Next slide
  • 35.
    Mismatch in Sensibleheat flux (W/m2) (06/18/2008) H Simulated H METRIC Finer resolution
  • 36.
    Results and discussions 30thousand pixels Two different dates 05/17/2008 and 06/18/2008 Phase 1
  • 37.
    Results and discussions Soilevaporation (Ess) (mm/hr) Canopy transpiration(T) (mm/hr) ETins(mm/hr) (METRIC) Phase 1 + =
  • 38.
    Results and discussions Soilsurface evaporation(rss) (s/m) Canopy resistance(rsc) (s/m) Phase 1 Low rss Low rsc High rsc High rss
  • 39.
    Phase 1 –Inversion of METRIC ET Parameterize of Soil moisture at surface and root zone ET METRIC (mm/hr) Soil moisture at surface (θss) (m3/m3) Soil moisture at rootzone (θroot) (m3/m3) θroot : (0.18-0.22 m3/m3 High θsur
  • 40.
    Phase 2 and3  Extrapolation of ET  Calibration of the Model  Adjustment of ET
  • 41.
    Soil water balance 𝛉𝐬𝐮𝐫(𝐢) = 𝛉 𝐬𝐮𝐫(𝐢−𝟏) + 𝐏(𝐢) + 𝐈 𝐫𝐫(𝐢) − 𝐒 𝐫𝐮𝐧(𝐢) − 𝐄 𝐬𝐬(𝐢) 𝐝 𝐬𝐮𝐫 𝐢𝐟 𝛉𝐬𝐮𝐫𝐢 ≤ 𝛉𝐟𝐜 𝐢𝐟 𝛉𝐬𝐮𝐫𝐢 > 𝛉𝐟𝐜 𝛉𝐟𝐜 𝛉 𝐬𝐮𝐫(𝐢) = 𝛉 𝐬𝐮𝐫(𝐢−𝟏) + 𝐏(𝐢) + 𝐈 𝐫𝐫(𝐢) − 𝐒 𝐫𝐮𝐧(𝐢) − 𝐄 𝐬𝐬(𝐢) − 𝐓𝐞(𝐢) 𝐝 𝐬𝐮𝐫 − 𝐃𝐏𝐞(𝐢) + 𝐂𝐑 𝐞(𝐢) Phase 2 - Soil surface layer (10cm) • 3 layered soil water balance model • 1st layer is evaporation layer • 2nd layer is canopy transpiration layer • 3rd layer deep percolation from root zone
  • 42.
    Soil water balance 𝛉𝐫𝐨𝐨𝐭(𝐢) = 𝛉 𝐫𝐨𝐨𝐭(𝐢−𝟏) + 𝐏(𝐢) + 𝐈 𝐫𝐫(𝐢) − 𝐒 𝐫𝐮𝐧(𝐢) − 𝐓(𝐢) − 𝐄 𝐬𝐬(𝐢) 𝐝 𝐫𝐨𝐨𝐭 𝐢𝐟 𝛉 𝐫𝐨𝐨𝐭(𝐢) ≤ 𝛉𝐟𝐜 𝛉𝐟𝐜 𝐢𝐟 𝛉 𝐫𝐨𝐨𝐭(𝐢) > 𝛉𝐟𝐜 𝛉 𝐫𝐨𝐨𝐭(𝐢) = 𝛉 𝐫𝐨𝐨𝐭(𝐢−𝟏) + 𝐏(𝐢) + 𝐈 𝐫𝐫(𝐢) − 𝐒 𝐫𝐮𝐧(𝐢) − 𝐓(𝐢) − 𝐄 𝐬𝐬(𝐢) 𝐝 𝐫𝐨𝐨𝐭 − 𝐃𝐏 𝐢 + 𝐂𝐑(𝐢) Phase 2 - Root zone layer (1-2m) • 1st (evaporation) layer is subset of 2nd layer • Sub-setting allows track evaporation from soil surface and transpiration from root zone simultaneously
  • 43.
    Soil water balance Anillustration ( 3 hours time steps) Index no. Date P Irr Srun Ess T Total water (root zone) Total water (surface) mm mm mm mm mm mm mm 1 5/17/08 14:00 0.0359 2.35 197.68 2.27 2 5/17/08 17:00 0.0170 1.26 196.40 2.25 3 5/17/08 20:00 0.0173 1.25 195.13 2.23 4 5/17/08 23:00 0.0158 0.06 195.06 2.22 5 5/18/08 2:00 0.0043 0.05 195.01 2.21 6 5/18/08 5:00 0.0043 0.04 194.96 2.21 7 5/18/08 8:00 0.0099 1.06 193.89 2.20 8 5/18/08 11:00 0.0217 2.21 191.66 2.18 9 5/18/08 14:00 0.0195 2.43 189.20 2.16 10 5/18/08 17:00 0.0137 2.04 187.15 2.14 11 5/18/08 20:00 0.0108 1.86 185.29 2.13 12 5/18/08 23:00 0.0095 0.05 185.23 2.12 13 5/19/08 2:00 0.0041 0.04 185.18 2.12 14 5/19/08 5:00 0.0041 0.03 185.15 2.11 15 5/19/08 8:00 0.0091 1.00 184.15 2.10 16 5/19/08 11:00 0.0203 2.05 182.07 2.08 17 5/19/08 14:00 0.0193 2.14 179.92 2.06 18 5/19/08 17:00 0.0107 1.31 178.60 2.05
  • 44.
    Irrigation sub-model Irr(i) = (θfc−θroot i ) droot if θroot i < θt 0 if θroot(i) ≥ θt θt = θfc − RAW Phase 2 When soil moisture at root zone is below threshold moisture content (θt), vegetation starts to stress
  • 45.
    Phase 2 –Extrapolation of ET (mm/hr) Phase 2 - One day evaluation Change in solar radiation Change in canopy resistance
  • 46.
    Results and discussion Phase2 -Next satellite passing date (06/18/2008) (per. 05/17 – 06/18) ET Simulated (mm/hr) ET METRIC (mm/hr) NDVI Mismatch Mismatch: Irrigation timing, aerodynamic and radiometric temperature, zoh, partitioning of the fluxes
  • 47.
    Results and discussionsET ET hourly ET daily Phase 2 (06/18/2008, before adjustment) Daily ET is computed letting the extrapolation model run beyond the satellite overpass time for a full day without interrupting at a satellite overpass time
  • 48.
    Results and discussions DailyET from 05/17/2008 to 06/18/2008 A1: Irrigated agricultural pixel (Landuse: 82, NDVI: 0.71 to 0.83 and fc: 0.86 to 1) A2: Irrigated agricultural pixel (Landuse 82, NDVI : 0.12 to 0.32 and fc : 0.05 to 0.27) D1: Desert pixel (Landuse 52, NDVI: 0.2 to 0.17, fc: 0.28) Phase 2 (before adjustment) 0 2 4 6 8 10 12 136 141 146 151 156 161 166 171 ET(mm/day) Day of the year ET_A1 ET_A2 ET_D1 ETr Follows very well the reference ET
  • 49.
    Results and discussions FluxesMETRIC Results (06/18/2008 11am.) Simulated Results (Extrapolation model) (06/18/2008 11am.) Simulated Results (Inversion model) (06/18/2008 11 am.) 1 2 3 4 5 6 7 8 9 10 11 12 13 14 ET Mean Standard deviation Mean Standard Deviation R2 Slope Intercept MAE RMSE E di Mean Standard Deviation (mm/hr) mm/hr) (mm/hr) (mm/hr) (mm/hr) (mm/hr) (mm/hr) URA AOI 0.62 0.20 0.62 0.29 0.63 1.17 -0.11 0.13 0.18 0.16 0.67 0.62 0.2 BLA AOI 0.59 0.19 0.54 0.3 0.66 1.2 -0.20 0.15 0.19 0.04 0.66 0.59 0.19 MD AOI 0.16 0.04 0.18 0.04 0.61 0.66 0.7 0.02 0.03 0.44 0.65 0.16 0.05 Temperature (Tb) K K K K K URA AOI 303.1 6.5 302.7 3.17 0.59 0.57 128.4 3.17 4.18 0.59 0.67 302.3 3.8 BLA AOI 304.0 5.8 304.0 4.6 0.52 0.90 28.7 3.2 4.09 0.51 0.65 303.2 3.2 MD AOI 322.1 0.87 309.5 0.54 0.00 -0.04 323.49 12.63 12.67 -206.5 0.05 309.0 0.7 Ground heat flux (G) W/m2 W/m2 W/m2 W/m2 W/m2 W/m2 W/m2 URA AOI 57.3 24.51 39.05 45.8 0.85 1.73 -60.41 28.1 30.9 -0.59 0.58 31.47 35.81 BLA AOI 70.4 44.0 49.68 48.53 0.38 0.56 42.3 34.7 45.3 -0.06 0.53 36.2 34.9 MD AOI 115.2 11.2 75.3 17.9 0.83 1.4 -92.69 39.9 40.8 -12.2 0.19 68.3 19.5 Sensible heat flux (H) W/m2 W/m2 W/m2 W/m2 W/m2 W/m2 W/m2 URA AOI 109.4 73.9 159.18 66.5 0.46 1.0 49.62 66.5 93.14 -0.58 0.54 177.62 67.4 BLA AOI 125.6 71.3 198.8 116.8 0.54 0.4 36.3 90.2 108.7 -1.3 0.49 195.6 75.3 MD AOI 288.0 28.1 369.55 8.5 0.24 -0.14 412.56 84.2 87.9 -8.7 0.18 383.84 11.4 Net radiation (Rn) W/m2 W/m2 W/m2 W/m2 W/m2 W/m2 W/m2 URA AOI 590.51 49.7 623.2 57.4 0.55 0.85 116.6 43.49 50.95 -0.04 0.56 631.3 46.9 BLA AOI 592.0 45.6 614.36 56.1 0.47 0.56 246.6 37.7 47.0 -0.05 0.57 626.72 40.67 MD AOI 508.7 13.6 568.22 14.17 0.01 -0.1 621.4 59.6 62.9 -20.4 0.15 576.4 15.7 Phase 2 – projected model results vs. METRIC (06/18)
  • 50.
    Results and discussions 0 1 2 3 4 50.0 0.2 0.4 0.6 0.8 1.0 1.2 1 31 61 91 121 151 181 211 241 P(mm/3hr) ET(mm/hr) Indexnumber (every 3 hours) P ET_simulated Ess T NDVI Irrigated agricultural pixel (Landuse: 82, NDVI: 0.71 to 0.83 and fc: 0.86 to 1) from 05/17/2008 to 06/18/2008 0 1 2 3 4 50.0 0.1 0.2 0.3 0.4 0.5 0.6 0.7 0.8 0.9 1 31 61 91 121 151 181 211 241 P(mm/3hr) ET(mm/hr) Index number (every 3 hours) P ET_modeled Ess T NDVI Irrigated agricultural ET (Landuse 82, NDVI : 0.12 to 0.32 and fc : 0.05 to 0.27) from 05/17/2008 to 06/18/2008 Phase 2 (before adjustment)
  • 51.
    Results and discussions 0 80 160 240 1 31 61 91 121 151 181 211 241 Cumulativewater(mm) Indexnumber (every 3 hours ) Cum_P Cum_ET Cum_Irri Cum_Dep Cum_ETr 0 80 160 240 1 31 61 91 121 151 181 211 241 Cumulativewater(mm) Index number (every 3 hours ) Cum_P Cum_ET Cum_Irri Cum_Dep Cum_ETr A2: Irrigated agricultural pixel (Landuse 82, NDVI: 0.12 to 0.32 and fc: 0.05 to 0.27) from 05/17/2008 to 06/18/2008 A1: Irrigated agricultural pixel (Landuse: 82, NDVI: 0.71 to 0.83 and fc: 0.86 to 1) from 05/17/2008 to 06/18/2008 Phase 2 High cumulative ET and near reference level Low cumulative ET compared to pixel A1
  • 52.
    Results and discussions 0 1 2 3 4 50 800 1600 2400 3200 4000 4800 1 31 61 91 121 151 181 211 241 P(mm/3hr) Resistance(s/m) Indexnumber (every 3 hours) P rss rsc D1 :Desert pixel (Landuse 52, NDVI: 0.2 to 0.17, fc: 0.28) from 05/17/2008 to 06/18/2008 0 1 2 3 4 50 800 1600 2400 3200 4000 4800 1 31 61 91 121 151 181 211 241 P(mm/3hr) Resistances(s/m) Index number (every 3 hours) P rss rsc A1: Agricultural pixel (Landuse 82, NDVI: 0.71to 0.83 and fc: 0.86 to 1) from 05/17/2008 to 06/18/2008 Phase 2 rss respond according to P rss respond according to P and remained low as fc is near 1 rsc is low during daytime and elevate at night time because of no solar radiation
  • 53.
    Results and discussions 0 1 2 3 4 50.00 0.05 0.10 0.15 0.20 0.25 0.30 0.35 0.40 1 31 61 91 121 151 181 211 241 P(mm/3hr) Moisturecontent(m3/m3) Indexnumber (every 3 hours) P Soilm_root A1: Irrigated agricultural pixel (Landuse 82, NDVI: 0.71 to 0.83 and fc: 0.86 to 1) from 05/17/2008 to 06/18/2008 0 1 2 3 4 50.00 0.05 0.10 0.15 0.20 0.25 0.30 0.35 0.40 1 31 61 91 121 151 181 211 241 P(mm/3hr) Moisturecontent(m3/m3) Index number (every 3 hours) Precip Soilm_sur Soilm_root A2: Irrigated agricultural pixel (Landuse 82, NDVI: 0.12 to 0.32 and fc: 0.05 to 0.27) from 05/17/2008 to 06/18/2008 Phase 2 θroot decreased faster as T is high θsur responded rapidly with P as fc is low θroot decreased slowly as fc is low
  • 54.
    Correction of ET ETC(i)= ETS(i) − Err i − i(S) i(E) − i(S) Error Map 06/18/2008 11am Phase 3 𝐸𝑟𝑟= 𝐸𝑇𝑠 𝐸 - 𝐸𝑇 𝑀 𝐸ET is adjusted linearly assuming that error grows at the same rate over the time
  • 55.
    Correction of ET 0 1 2 3 4 50.0 0.2 0.4 0.6 0.8 1.0 1.2 1 31 61 91 121 151 181 211 241 P(mm) ET(mm/hr) Indexnumber (every 3 hours) P ET_simulated ET_cor 0 1 2 3 4 50.0 0.2 0.4 0.6 0.8 1 31 61 91 121 151 181 211 241 P(mm) ET(mm/hr) Index number (every 3 hours) P ET_modeled ET_cor A1: Irrigated agricultural pixel (Landuse: 82, NDVI: 0.71 to 0.83 and fc: 0.86 to 1) from 05/17/2008 to 06/18/2008 A2: Irrigated agricultural pixel (Landuse 82, NDVI: 0.12 to 0.32 and fc: 0.05 to 0.27) from 05/17/2008 to 06/18/2008 Phase 3 ( Adjustment of ET) Least correction High correction
  • 56.
    Results and discussions 0 0.2 0.4 0.6 0.8 1 1.2 136141 146 151 156 161 166 171 176 ETrF Day of the year ETrF_sim ETrF_METRIC ETrF_cor A2: Irrigated agricultural pixel (Landuse 82, NDVI: 0.12 to 0.32 and fc: 0.05 to 0.27) from 05/17/2008 to 06/18/2008 Phase 3 (Adjustment of ETrF) Simulated ETrF is low because of mismatch of Irr 2424 rETF r ETET 
  • 57.
    Comparison of Hydrus1D and FAO-56 Paper 3 𝜕θ 𝜕t = 𝜕 𝜕x K(h) 𝜕h 𝜕x + Cosθ − S Hydrus-1D - Richards’ Equation −K h 𝜕h 𝜕x + 1 ≤ Emax at z = L θ is the angle between the flow direction and the vertical axis (i.e., γ = 00 for vertical flow, 900 for horizontal flow) x is the spatial coordinate (positive upward) i.e. x = L at soil surface and x = 0 at the bottom of the soil profile h : pressure head K(h): Unsaturated hydraulic conductivity Hydrus 1D mode (Šimůnek, 2008)
  • 58.
    FAO 56 FAO 56– Mass balance of water Kr is a soil evaporation reduction coefficient that is multiplied by the potential evaporation rate De is cumulative depth of evaporation (depletion) Paper 3 Kr = min TEW − De(i−1) ) (TEW − REW) , 1.0 0.0 ≤ Dei = Dei−1 − 1 − fb Pi− ROi + Ii fw + fb Pi+1 − ROi+1 + Ii+1 fw + Ei few + Tei ≤ TEW TEW : Total evaporable water REW: Readily evaporable water De = Depletion fb : fraction of the precipitation and irritation occurring during a time step that contributes to evaporation during the same time step (fb = 0 to 1), few : wetted fraction of the soil surface layer, fw: fraction of soil surface that is wetted, Tei : depth of transpiration extracted from the exposed and wetted fraction of the soil surface layer (few), Ei : evaporation during timestep (Allen et al., 1998, Allen, 2011)
  • 59.
    FAO 56 FAO 56– Mass balance of water Stage 1 : Energy limiting stage Stage 2 : Falling stage Evaporation is only limited by energy available, no resistance from soil Evaporation is limited by soil resistance ET is in reference level ET is smaller than reference level E2 = Kr Ke maxETr Kemax : potential rate of evaporation relative to the reference ET ETr: Reference ET based on alfalfa E1 = Ke maxETr
  • 60.
    Standard input forFAO-56 and Hydrus-1D Soil Properties Symbol Units Silt Loam Field Capacity water content θfc m3/m3 0.36 Wilting Point water content θwp m3/m3 0.22 Depth of Surface Soil Layer subjected to Drying by Evaporation Ze m 0.1 Total Evaporable Water (calculated) TEW mm 25 Readily Evaporable Water REW mm 8 Soil Properties Symbol Units Sandy Clay Loam Silt Loam Silt Residual soil water content θr m3/m3 0.1 0.067 0.034 Saturated soil water content θs m3/m3 0.39 0.45 0.46 Parameter α in the soil water retention function [L-1] α mm-1 0.0059 0.002 0.0016 Parameter n in the soil water retention function n 1.48 1.41 1.37 Saturated hydraulic conductivity, Ks [LT-1] Ks mm/day 314.5 108 60 Tortuosity parameter in the conductivity function Tr 0.5 0.5 0.5 FAO 56 Hydrus 1D Paper 3
  • 61.
    Comparison of FAO-56,Hydrus-1D and Lysimeter 0 25 50 75 1000.0 0.2 0.4 0.6 0.8 1.0 1.2 1.4 1.6 1.8 2.0 8/5/1977 8/7/1977 8/9/1977 8/11/1977 8/13/1977 8/15/1977 8/17/1977 8/19/1977 8/21/1977 8/23/1977 8/25/1977 8/27/1977 8/29/1977 8/31/1977 9/2/1977 9/4/1977 9/6/1977 9/8/1977 9/10/1977 9/12/1977 9/14/1977 9/16/1977 9/18/1977 9/20/1977 9/22/1977 9/24/1977 Precip.+Irri.(mm/day) Ke Precip (mm) Ke (FAO-56 with skin evaporation) Ke (HYDRUS 1D -3m) Lysimeter Ke(FAO-56) 0 25 50 75 1000.0 1.0 2.0 3.0 4.0 5.0 6.0 7.0 8.0 9.0 10.0 8/5/1977 8/7/1977 8/9/1977 8/11/1977 8/13/1977 8/15/1977 8/17/1977 8/19/1977 8/21/1977 8/23/1977 8/25/1977 8/27/1977 8/29/1977 8/31/1977 9/2/1977 9/4/1977 9/6/1977 9/8/1977 9/10/1977 9/12/1977 9/14/1977 9/16/1977 9/18/1977 9/20/1977 9/22/1977 9/24/1977 Precipi+Irri.(mm/day) Evaporation(mm/day) Precip (mm) Es (FAO 56 with skin evaporation) Es (HYDRUS 1D -3m) Lysimeter FAO-56 Paper 3 Daily comparison
  • 62.
    Comparison of Hydrus1D and FAO-56 0 25 50 75 1000.0 20.0 40.0 60.0 80.0 100.0 120.0 140.0 8/5/1977 8/7/1977 8/9/1977 8/11/1977 8/13/1977 8/15/1977 8/17/1977 8/19/1977 8/21/1977 8/23/1977 8/25/1977 8/27/1977 8/29/1977 8/31/1977 9/2/1977 9/4/1977 9/6/1977 9/8/1977 9/10/1977 9/12/1977 9/14/1977 9/16/1977 9/18/1977 9/20/1977 9/22/1977 9/24/1977 Precip.+Irri.(mm/day) Cum.ET(mm) Precip (mm) Ke (FAO 56 with skin evaporation) Ke (HYDRUS 1D -3m) Lysimeter y = 0.97x - 0.57 R² = 0.83 0.0 1.0 2.0 3.0 4.0 5.0 6.0 7.0 8.0 0.0 1.0 2.0 3.0 4.0 5.0 6.0 7.0 8.0 Evaporation(mm)FAO56 Evaporation (mm) Lysimeter y = 1.03x - 0.38 R² = 0.88 0.0 1.0 2.0 3.0 4.0 5.0 6.0 7.0 8.0 0.0 1.0 2.0 3.0 4.0 5.0 6.0 7.0 8.0 Evaporation(mm)FAO56- skin Evaporation (mm) Lysimeter Paper 3 Daily comparison
  • 63.
    0 5 10 15 200.0 0.2 0.4 0.6 0.8 1.0 1.2 Precipitation(mm/day) Ker Precip (mm) FAO56 HYDRUS 1D -0.5m 0 5 10 15 200.0 0.2 0.4 0.6 0.8 1.0 1.2 1/1/2002 1/16/2002 1/31/2002 2/15/2002 3/2/2002 3/17/2002 4/1/2002 4/16/2002 5/1/2002 5/16/2002 5/31/2002 6/15/2002 6/30/2002 7/15/2002 7/30/2002 8/14/2002 8/29/2002 9/13/2002 9/28/2002 10/13/2002 10/28/2002 11/12/2002 11/27/2002 12/12/2002 12/27/2002 Precipitation(mm/day) Ker Precip (mm) FAO 56 - skin HYDRUS 1D -0.5m Comparison of Hydrus-1D and FAO-56 Paper 3 Daily comparison
  • 64.
    0 5 10 15 200.0 0.2 0.4 0.6 0.8 1.0 1.2 Precipitation(mm) Ker Precip (mm) FAO56 - skin HYDRUS 1D -3.0m 0 5 10 15 200.0 1.0 2.0 3.0 4.0 5.0 6.0 7.0 1/1/2002 1/16/2002 1/31/2002 2/15/2002 3/2/2002 3/17/2002 4/1/2002 4/16/2002 5/1/2002 5/16/2002 5/31/2002 6/15/2002 6/30/2002 7/15/2002 7/30/2002 8/14/2002 8/29/2002 9/13/2002 9/28/2002 10/13/2002 10/28/2002 11/12/2002 11/27/2002 12/12/2002 12/27/2002 Precipitation(mm/day) Evaporation(mm/day) Precip (mm) FAO 56 - skin HYDRUS 1D -3.0m Comparison of Hydrus-1D and FAO-56 0 5 10 15 200.0 50.0 100.0 150.0 200.0 250.0 300.0 1/1/2002 1/16/2002 1/31/2002 2/15/2002 3/2/2002 3/17/2002 4/1/2002 4/16/2002 5/1/2002 5/16/2002 5/31/2002 6/15/2002 6/30/2002 7/15/2002 7/30/2002 8/14/2002 8/29/2002 9/13/2002 9/28/2002 10/13/2002 10/28/2002 11/12/2002 11/27/2002 12/12/2002 12/27/2002 Precipitation(mm/day) Cum.Evap.(mm) Precip (mm) FAO 56 - skin HYDRUS 1D -3m y = 1.08x - 0.06 R² = 0.88 0.0 1.0 2.0 3.0 4.0 5.0 6.0 7.0 0.0 1.0 2.0 3.0 4.0 5.0 6.0 7.0 Evaporation(mm)FAO56 Evaporation (mm) HYDRUS 1D Paper 3 Daily comparison
  • 65.
    Conclusions and Recommendations Model was able to simulate reasonable values of surface energy fluxes  Simulation of ET between the satellite overpass dates without the thermal band based surface temperature was challenging  Model was able to simulate reasonable values of surface temperatures inside surface energy balance  NARR reanalysis data and METRIC data was able compute surface energy balance in between the satellite overpass dates  Difference in simulated and METRIC surface temperature create some differences in fluxes
  • 66.
    Conclusions and Recommendations Daily and hourly simulated ET followed the a similar pattern of ET as compared to METRIC at next satellite overpass date  Simulated soil surface resistance and canopy resistances using the soil water balance had expected values under wet and dry conditions  Irrigation sub-model was able to simulate irrigation in agricultural land  Mismatch in irrigation created differences ET in lower NDVI areas  Rooting depth is important in low NDVI areas where frequent irrigation is needed
  • 67.

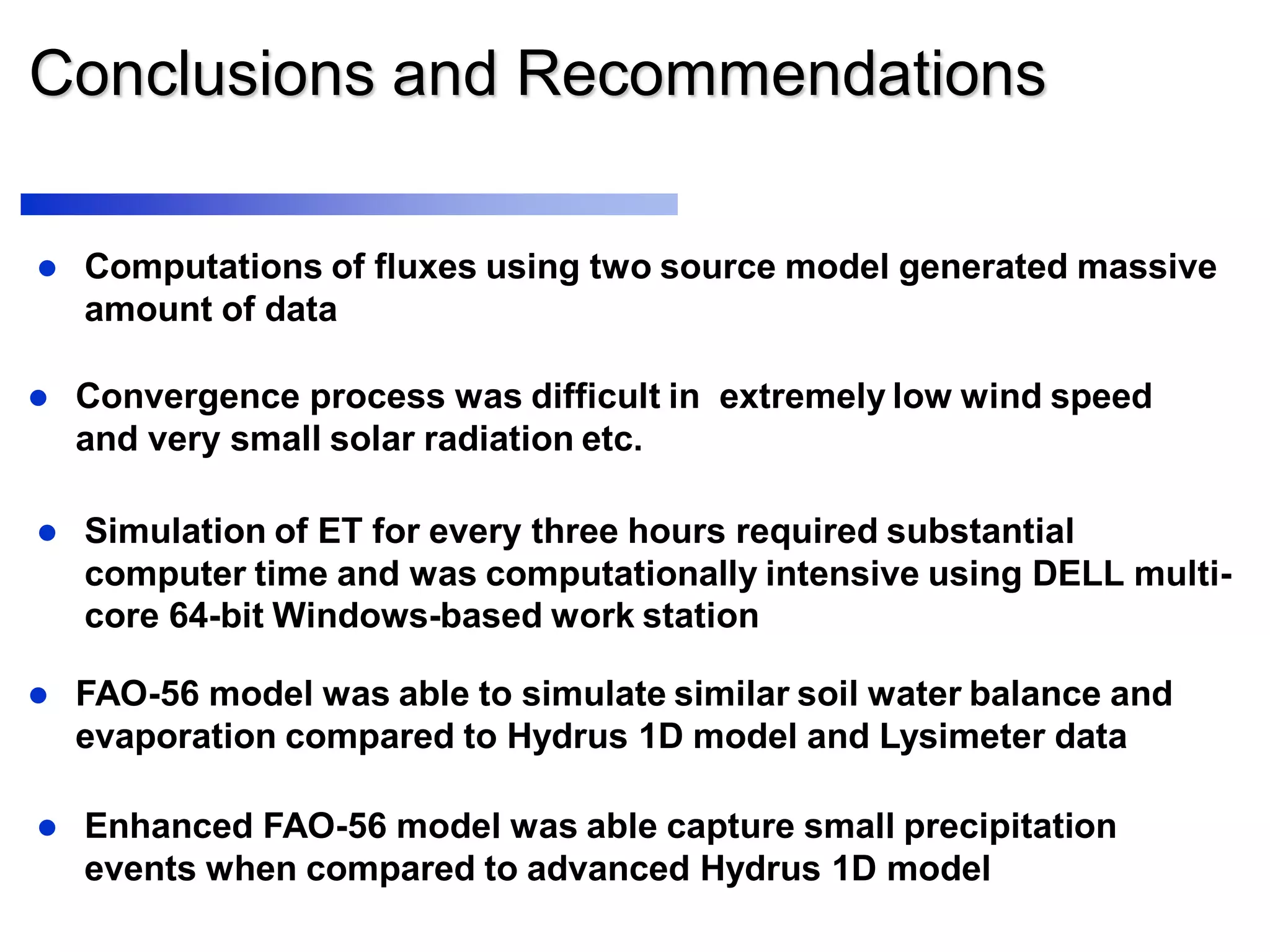

    Conclusions and Recommendations FAO-56 model was able to simulate similar soil water balance and evaporation compared to Hydrus 1D model and Lysimeter data  Computations of fluxes using two source model generated massive amount of data  Convergence process was difficult in extremely low wind speed and very small solar radiation etc.  Simulation of ET for every three hours required substantial computer time and was computationally intensive using DELL multi- core 64-bit Windows-based work station  Enhanced FAO-56 model was able capture small precipitation events when compared to advanced Hydrus 1D model
  • 68.
     Sensitivity analysisof higher blending height is recommended  Sensitivity analysis with other environmental factors in Jarvis function is recommended Conclusions and Recommendations  Dynamic rooting depth is recommended in irrigated agricultural land
  • 69.
    Thank you foryour time!!!!
