Agile Maturity
SCRUM + CMMI = SCRUMMI?
About Me
Project Management
   25+ Years
   PMP since 2001
   CSM since 2010

        Roles
          SCRUM Master and Coach
          Program Manager
          Project Manager
          CTO
          VP Operations, AFCEA Fort Knox Gold Vault Chapter
                CMMI Process Consultant
Agenda

•   Overview of CMMI
•   Agile Manifesto
•   Life Cycles
•   Life Cycle Division
•   Maturity Artifacts
•   Tools

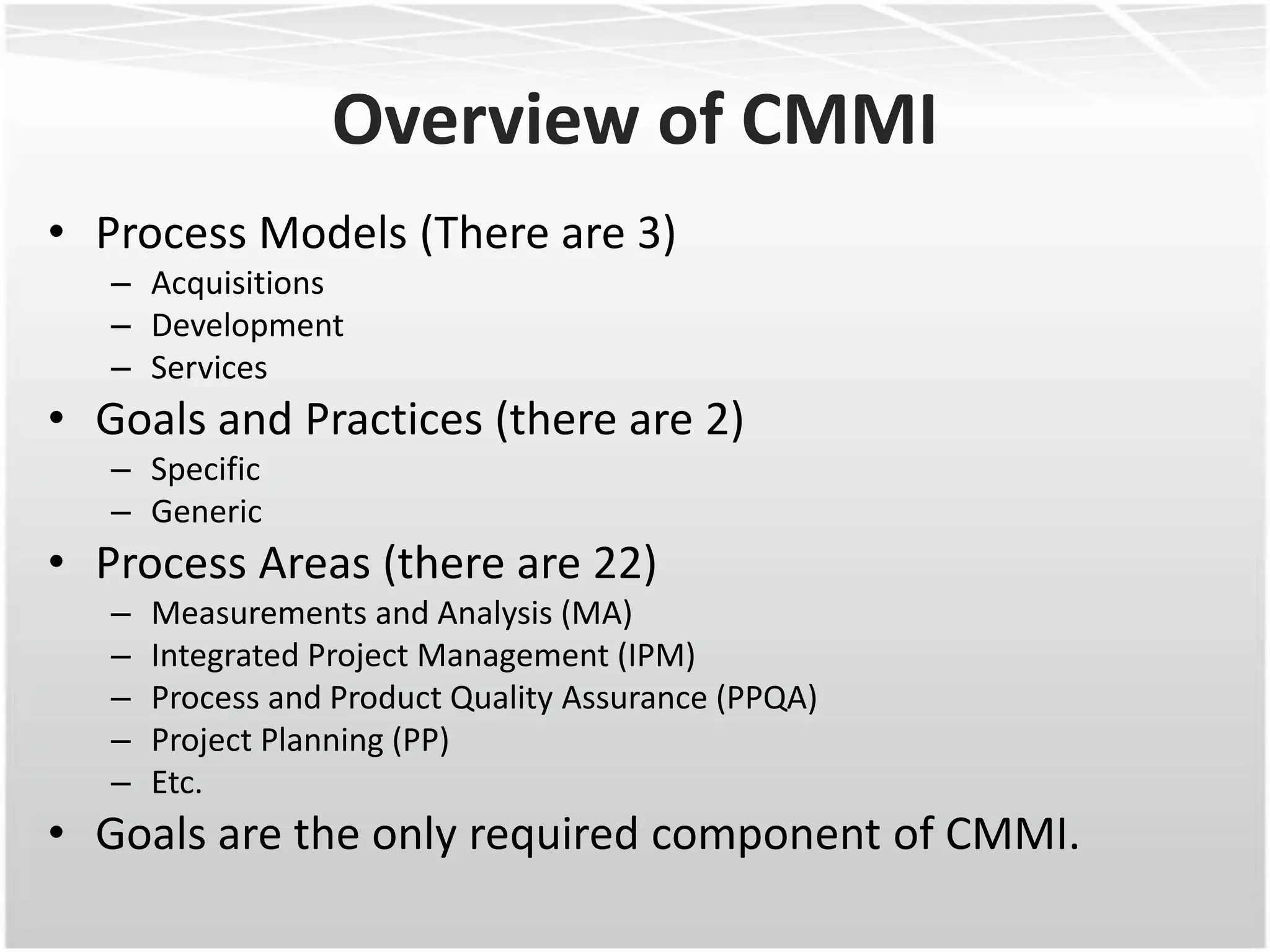

Overview of CMMI
• Process Models (There are 3)
   – Acquisitions
   – Development
   – Services
• Goals and Practices (there are 2)
   – Specific
   – Generic
• Process Areas (there are 22)
   –   Measurements and Analysis (MA)
   –   Integrated Project Management (IPM)
   –   Process and Product Quality Assurance (PPQA)
   –   Project Planning (PP)
   –   Etc.
• Goals are the only required component of CMMI.

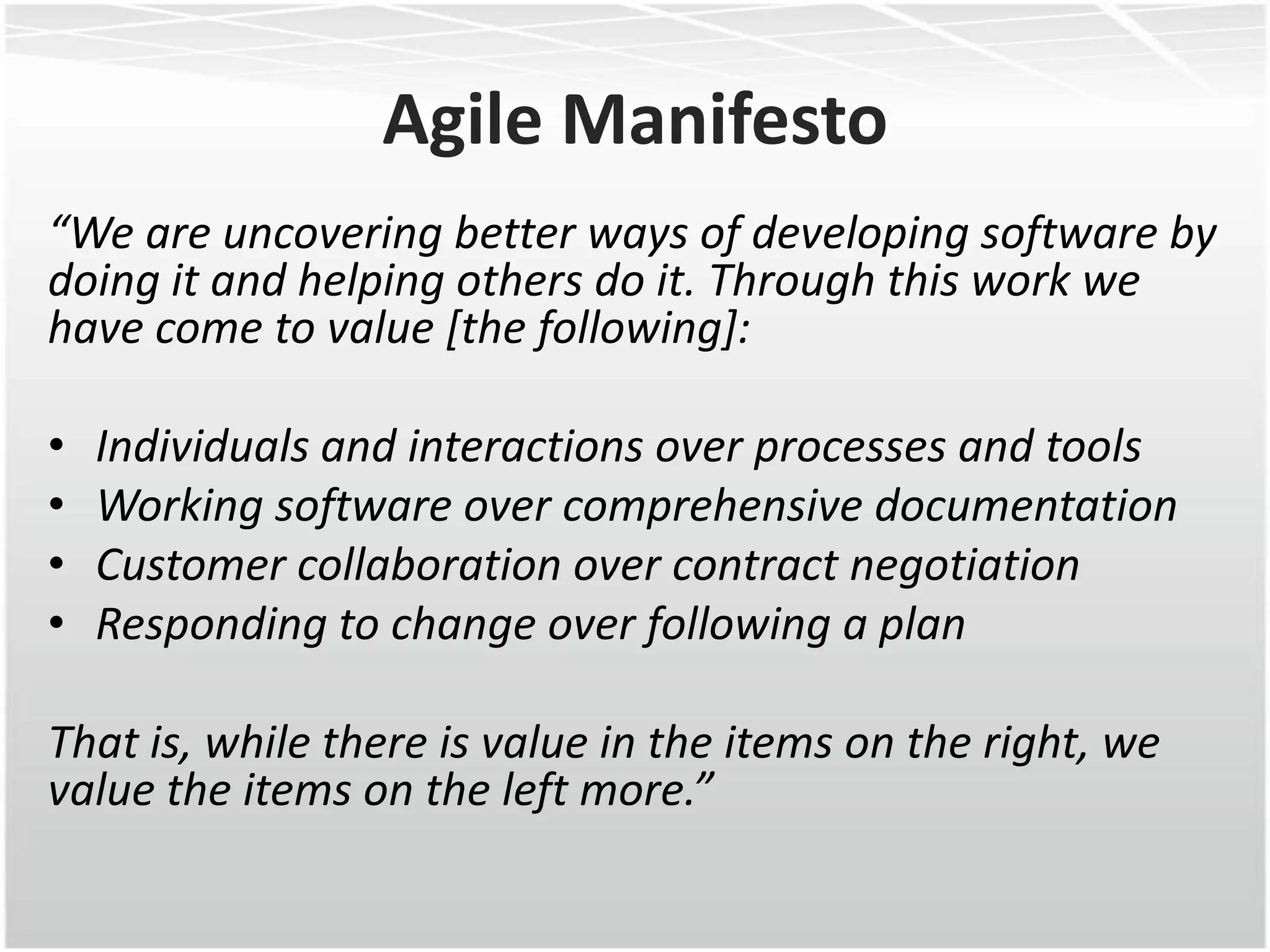

Agile Manifesto
“We are uncovering better ways of developing software by
doing it and helping others do it. Through this work we
have come to value [the following]:

•   Individuals and interactions over processes and tools
•   Working software over comprehensive documentation
•   Customer collaboration over contract negotiation
•   Responding to change over following a plan

That is, while there is value in the items on the right, we
value the items on the left more.”

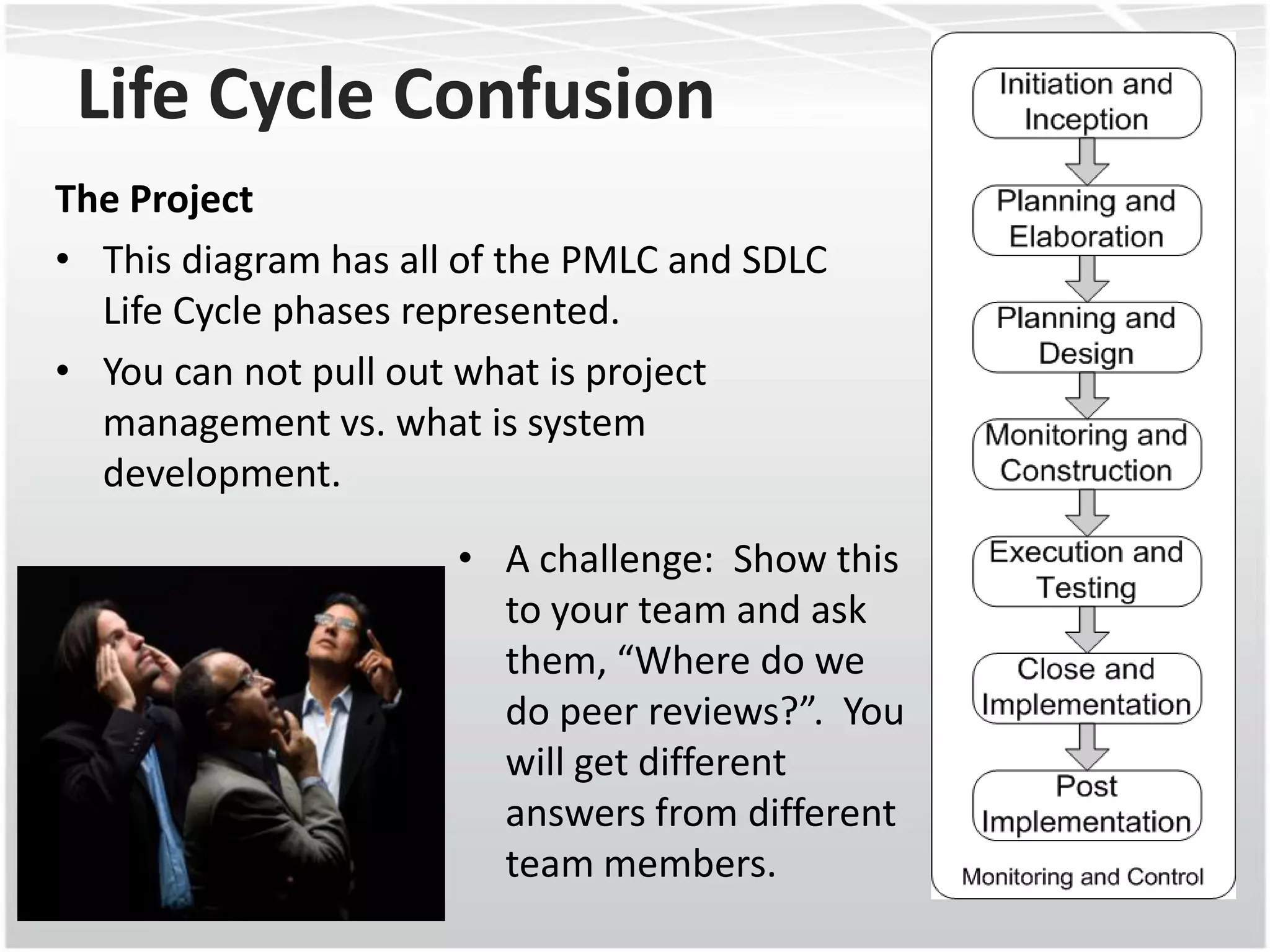

Life Cycle Confusion
The Project
• This diagram has all of the PMLC and SDLC
  Life Cycle phases represented.
• You can not pull out what is project
  management vs. what is system
  development.

                      • A challenge: Show this
                        to your team and ask
                        them, “Where do we
                        do peer reviews?”. You
                        will get different
                        answers from different
                        team members.

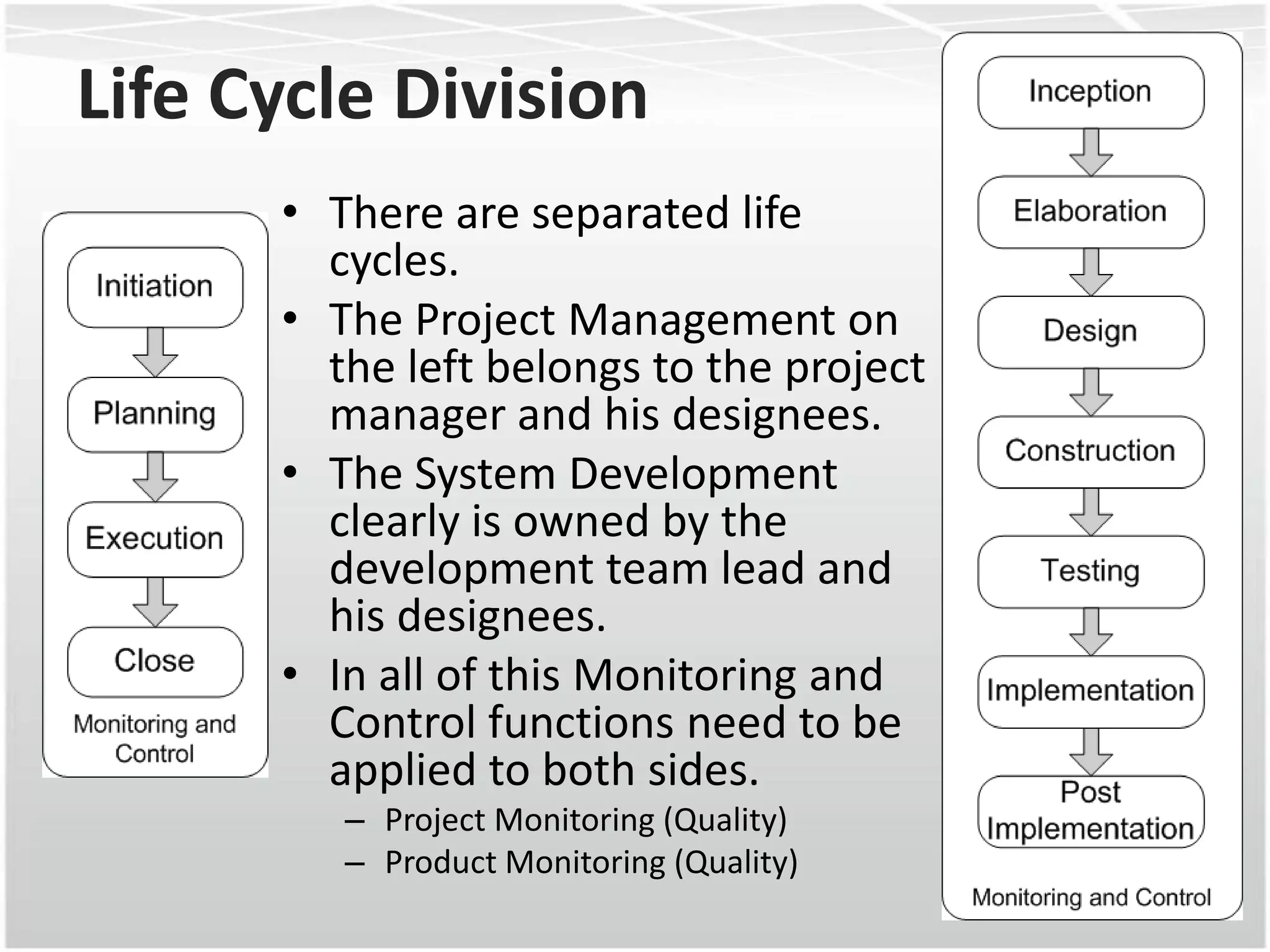

Life Cycle Division
      • There are separated life
        cycles.
      • The Project Management on
        the left belongs to the project
        manager and his designees.
      • The System Development
        clearly is owned by the
        development team lead and
        his designees.
      • In all of this Monitoring and
        Control functions need to be
        applied to both sides.
         – Project Monitoring (Quality)
         – Product Monitoring (Quality)

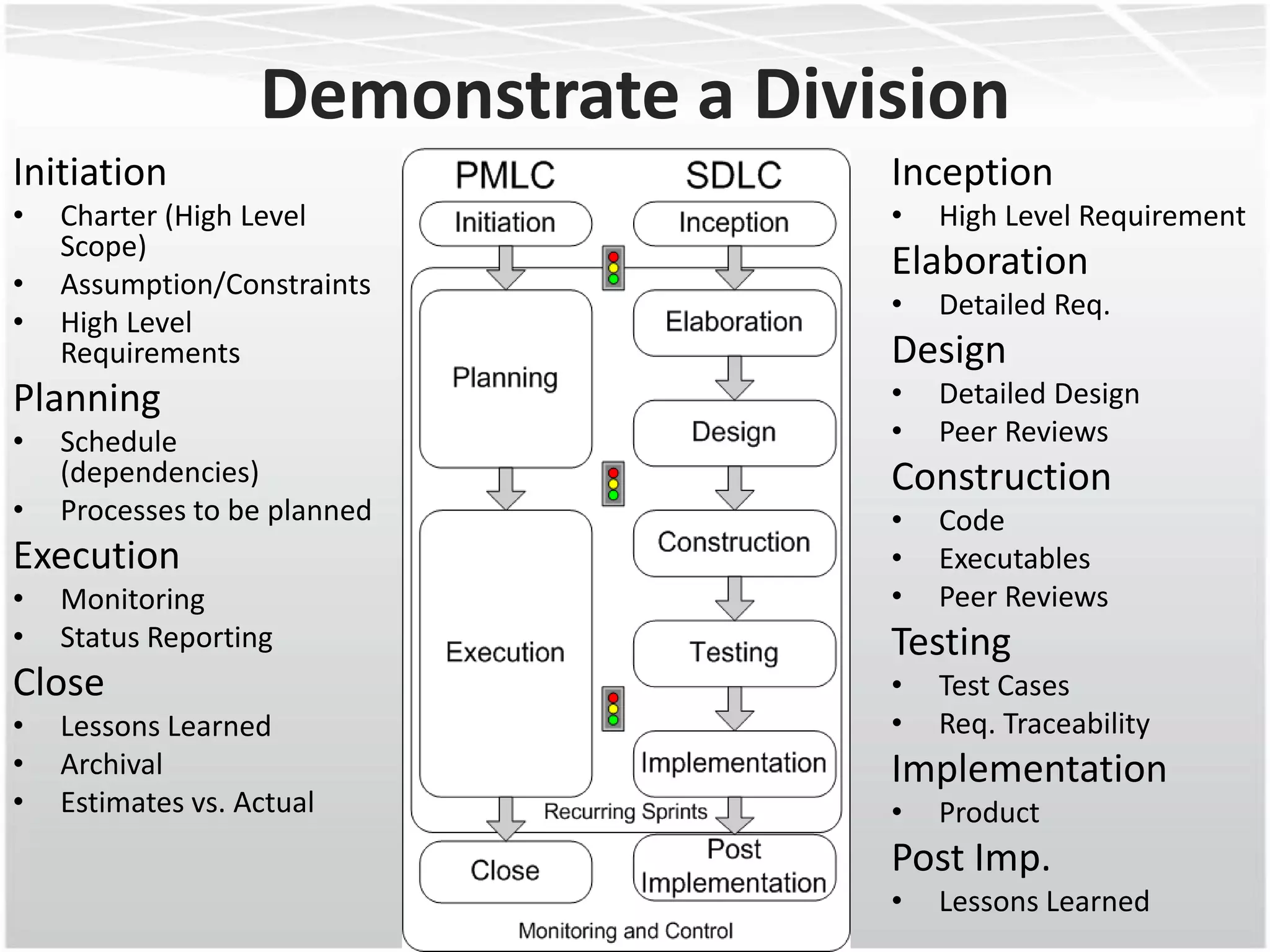

Demonstrate a Division
Initiation                           Inception
•   Charter (High Level              •   High Level Requirement
    Scope)
•   Assumption/Constraints
                                     Elaboration
                                     •   Detailed Req.
•   High Level
    Requirements                     Design
Planning                             •   Detailed Design
•   Schedule                         •   Peer Reviews
    (dependencies)                   Construction
•   Processes to be planned          •   Code
Execution                            •   Executables
•   Monitoring                       •   Peer Reviews
•   Status Reporting                 Testing
Close                                •   Test Cases
•   Lessons Learned                  •   Req. Traceability
•   Archival                         Implementation
•   Estimates vs. Actual             •   Product
                                     Post Imp.
                                     •   Lessons Learned

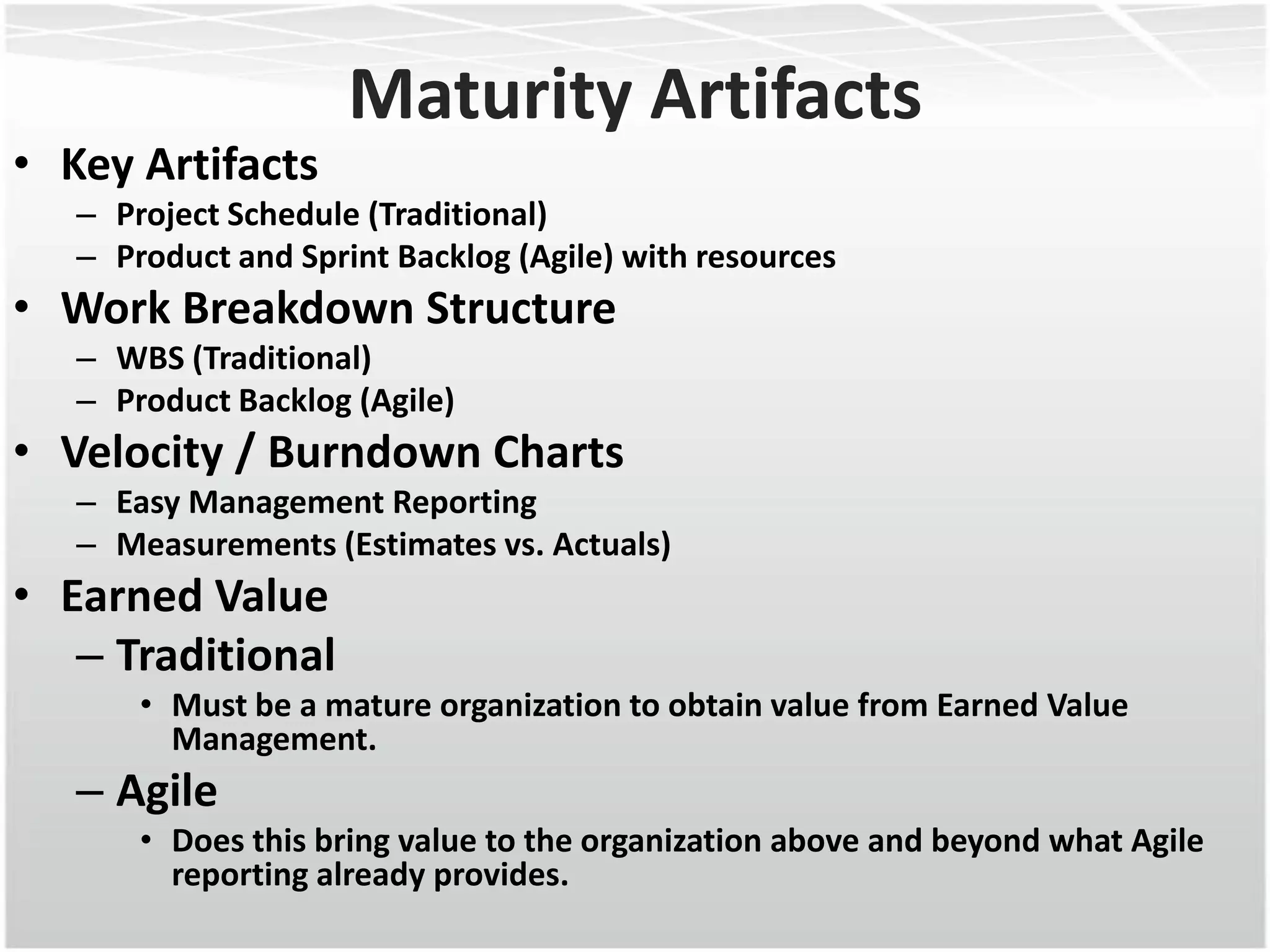

Maturity Artifacts
• Key Artifacts
   – Project Schedule (Traditional)
   – Product and Sprint Backlog (Agile) with resources
• Work Breakdown Structure
   – WBS (Traditional)
   – Product Backlog (Agile)
• Velocity / Burndown Charts
   – Easy Management Reporting
   – Measurements (Estimates vs. Actuals)
• Earned Value
   – Traditional
       • Must be a mature organization to obtain value from Earned Value
         Management.
   – Agile
       • Does this bring value to the organization above and beyond what Agile
         reporting already provides.

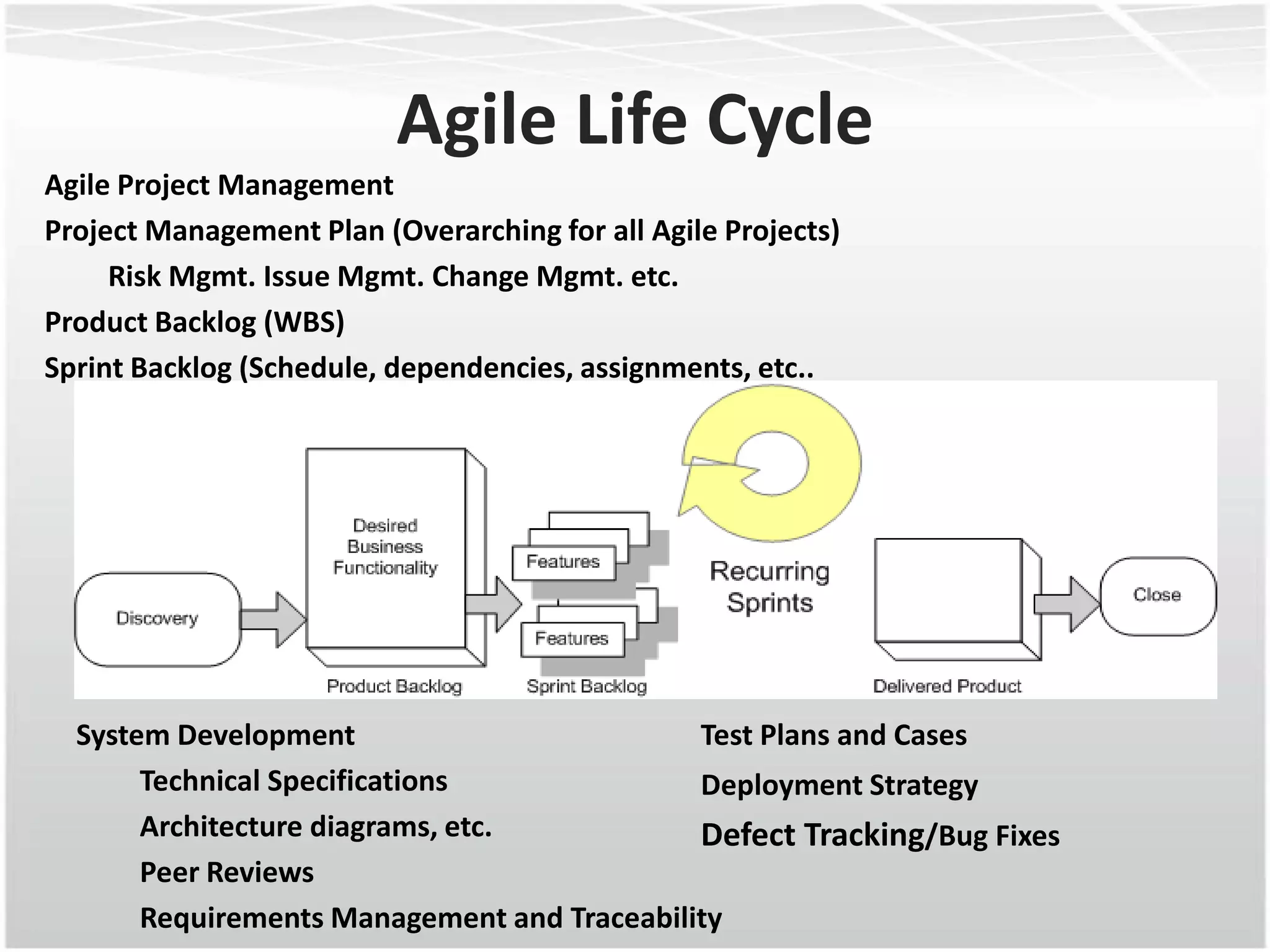

Agile Life Cycle
Agile Project Management
Project Management Plan (Overarching for all Agile Projects)
     Risk Mgmt. Issue Mgmt. Change Mgmt. etc.
Product Backlog (WBS)
Sprint Backlog (Schedule, dependencies, assignments, etc..

  System Development                         Test Plans and Cases
       Technical Specifications              Deployment Strategy
       Architecture diagrams, etc.           Defect Tracking/Bug Fixes
       Peer Reviews
       Requirements Management and Traceability
Demonstration

Excel Example: Sprint Backlog

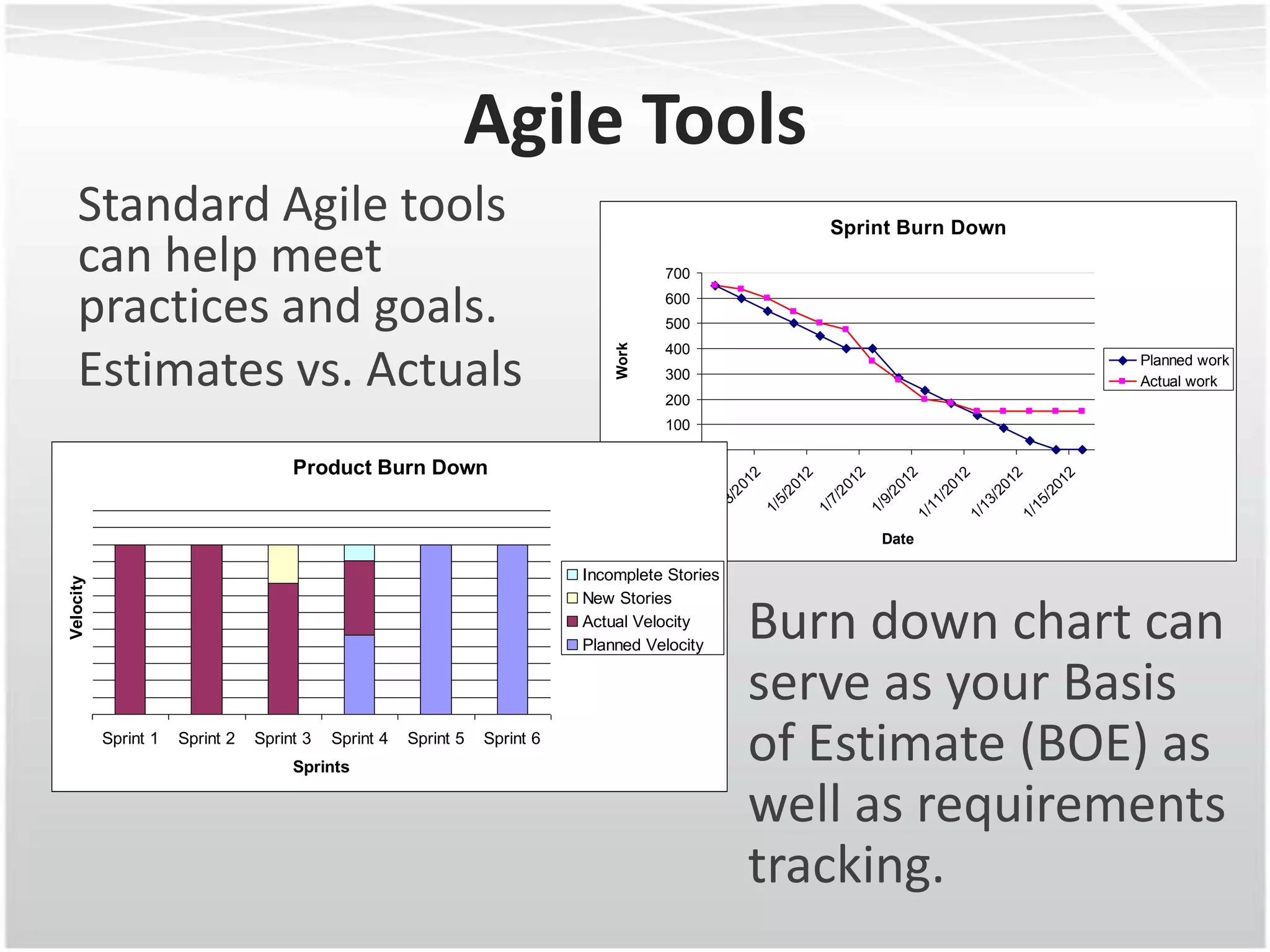

Agile Tools
   Standard Agile tools                                                                              Sprint Burn Down
   can help meet                                                                        700

   practices and goals.                                                                 600
                                                                                        500

                                                                                 Work
                                                                                        400

   Estimates vs. Actuals                                                                300
                                                                                        200
                                                                                                                        Planned work
                                                                                                                        Actual work

                                                                                        100
                                                                                          0
                                      Product Burn Down

                                                                                                12

                                                                                                12

                                                                                                12

                                                                                                12

                                                                                                12

                                                                                                 2

                                                                                                 2

                                                                                                 2
                                                                                               01

                                                                                               01

                                                                                               01
                                                                                              20

                                                                                              20

                                                                                              20

                                                                                              20

                                                                                              20

                                                                                             /2

                                                                                             /2

                                                                                             /2
                                                                                            1/

                                                                                            3/

                                                                                            5/

                                                                                            7/

                                                                                            9/

                                                                                           11

                                                                                           13

                                                                                           15
                                                                                         1/

                                                                                         1/

                                                                                         1/

                                                                                         1/

                                                                                         1/

                                                                                        1/

                                                                                        1/

                                                                                        1/
                                                                                                         Date

                                                                             Incomplete Stories
Velocity

                                                                             New Stories
                                                                             Actual Velocity
                                                                             Planned Velocity
                                                                                                  Burn down chart can
                                                                                                  serve as your Basis
           Sprint 1   Sprint 2   Sprint 3   Sprint 4
                                      Sprints
                                                       Sprint 5   Sprint 6
                                                                                                  of Estimate (BOE) as
                                                                                                  well as requirements
                                                                                                  tracking.
Measures and Analysis

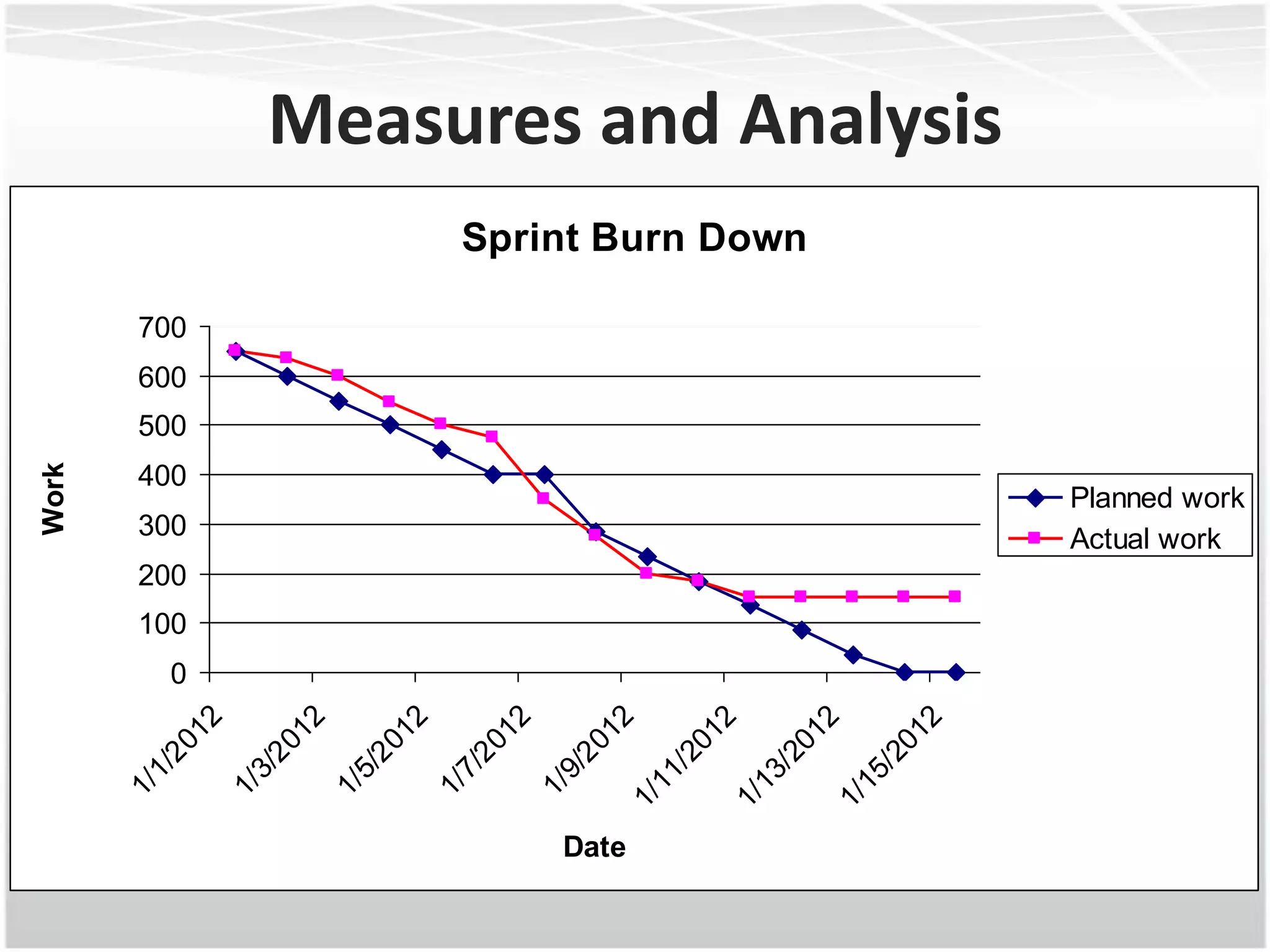

                  Sprint Burn Down

       700
       600
       500
Work

       400
                                     Planned work
       300                           Actual work
       200
       100
        0
               12

               12

               12

               12

               12

                2

                2

                2
              01

              01

              01
             20

             20

             20

             20

             20

            /2

            /2

            /2
           1/

           3/

           5/

           7/

           9/

          11

          13

          15
        1/

        1/

        1/

        1/

        1/

       1/

       1/

       1/             Date

Measures and Analysis
                                      Product Burn Down

                                                                             Incomplete Stories
Velocity

                                                                             New Stories
                                                                             Actual Velocity
                                                                             Planned Velocity

           Sprint 1   Sprint 2   Sprint 3   Sprint 4   Sprint 5   Sprint 6
                                      Sprints

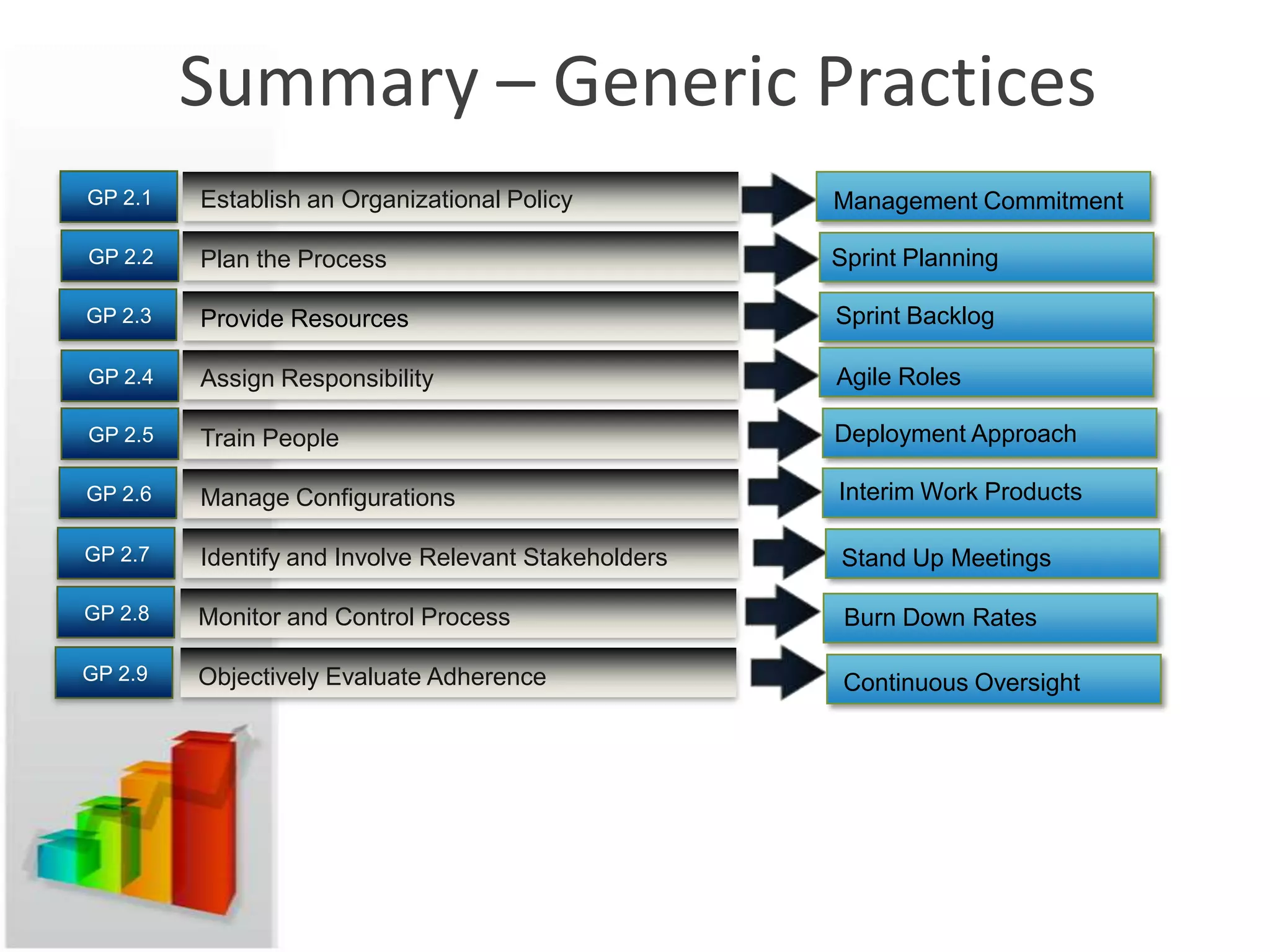

Summary – Generic Practices
GP 2.1   Establish an Organizational Policy           Management Commitment

GP 2.2   Plan the Process                             Sprint Planning

GP 2.3   Provide Resources                            Sprint Backlog

GP 2.4   Assign Responsibility                        Agile Roles

GP 2.5   Train People                                 Deployment Approach

GP 2.6   Manage Configurations                        Interim Work Products

GP 2.7   Identify and Involve Relevant Stakeholders   Stand Up Meetings

GP 2.8   Monitor and Control Process                   Burn Down Rates

GP 2.9   Objectively Evaluate Adherence                Continuous Oversight

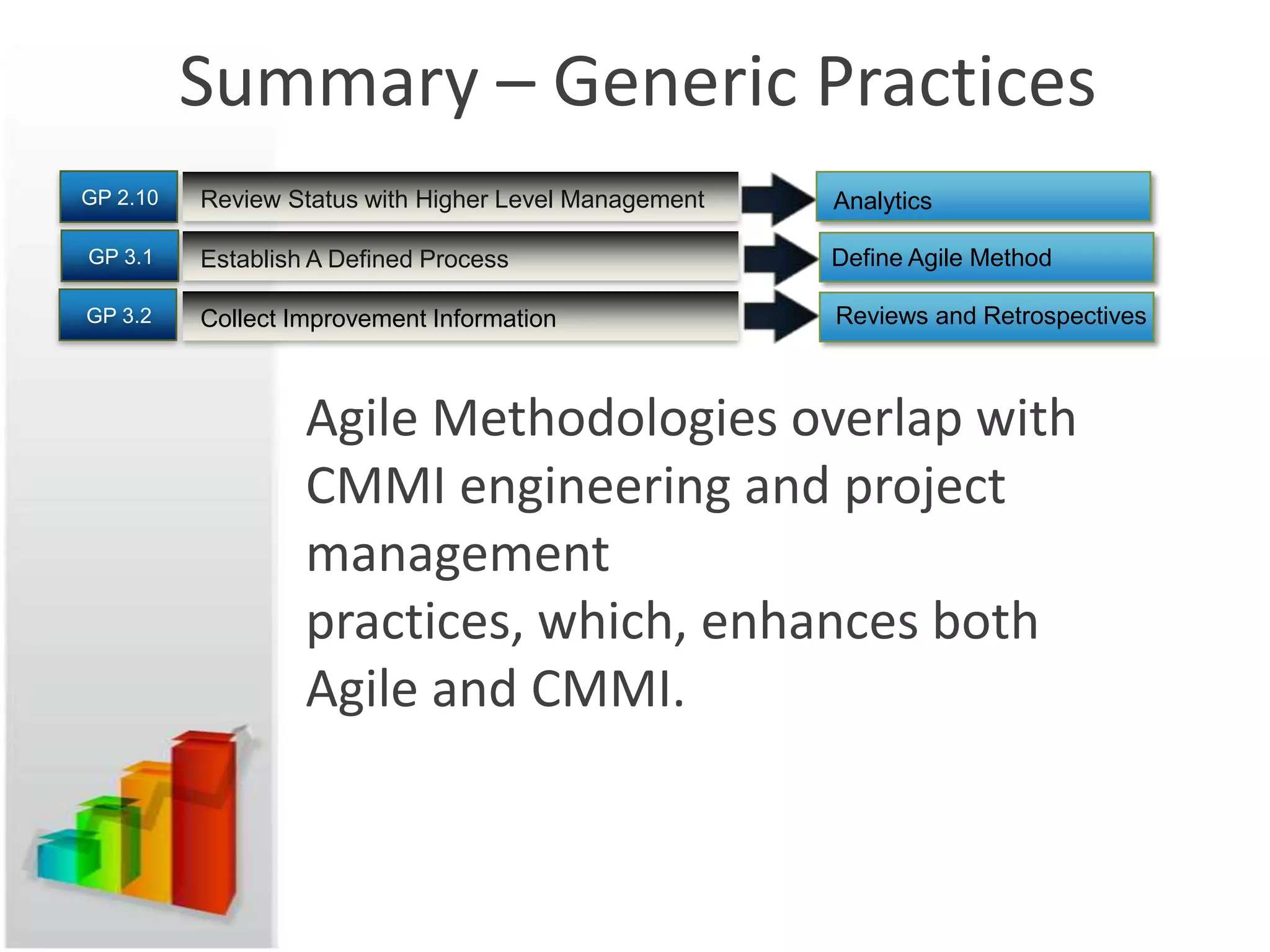

Summary – Generic Practices
GP 2.10   Review Status with Higher Level Management   Analytics

GP 3.1    Establish A Defined Process                  Define Agile Method

GP 3.2    Collect Improvement Information              Reviews and Retrospectives

                   Agile Methodologies overlap with
                   CMMI engineering and project
                   management
                   practices, which, enhances both
                   Agile and CMMI.
Questions?
