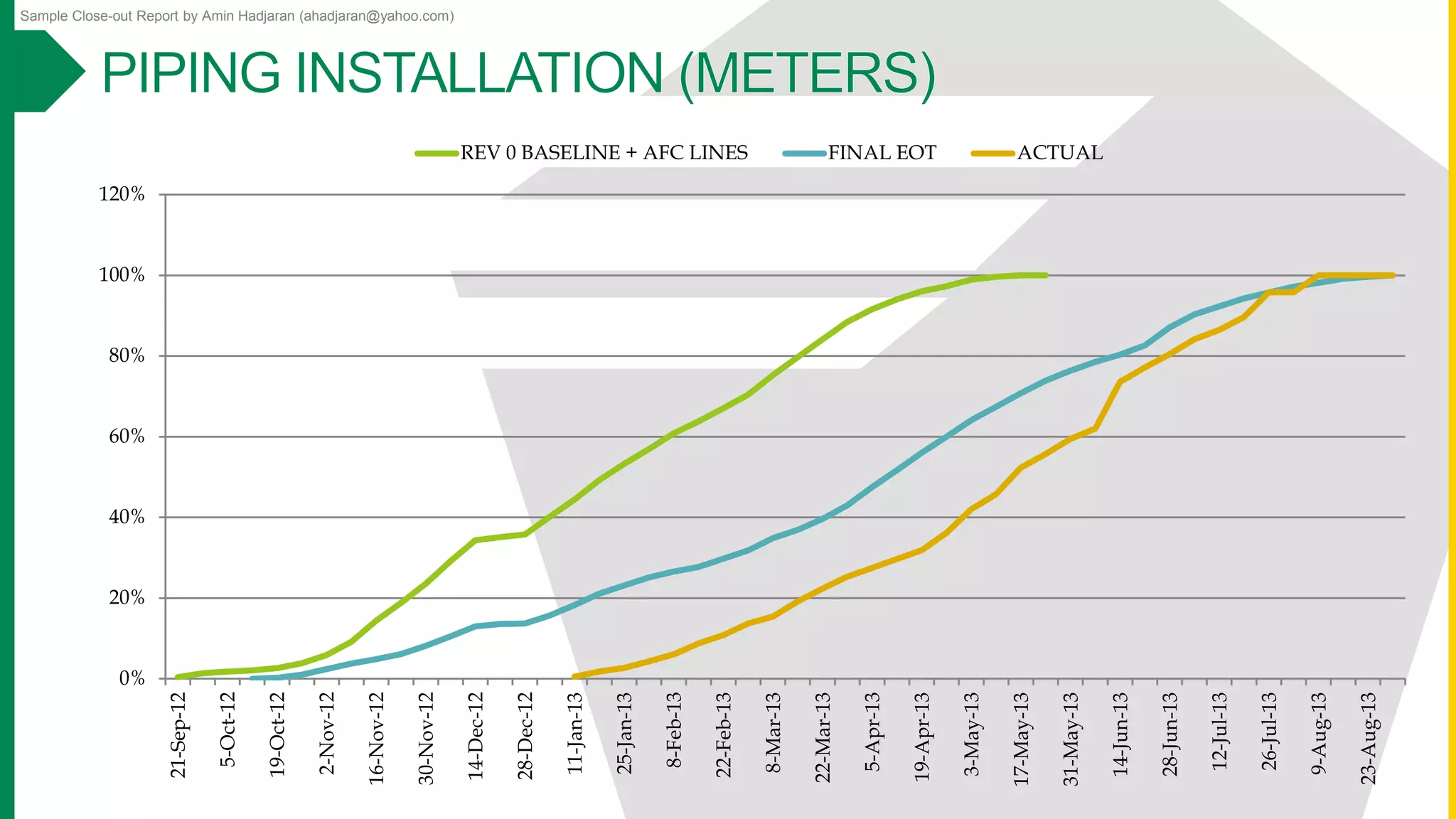

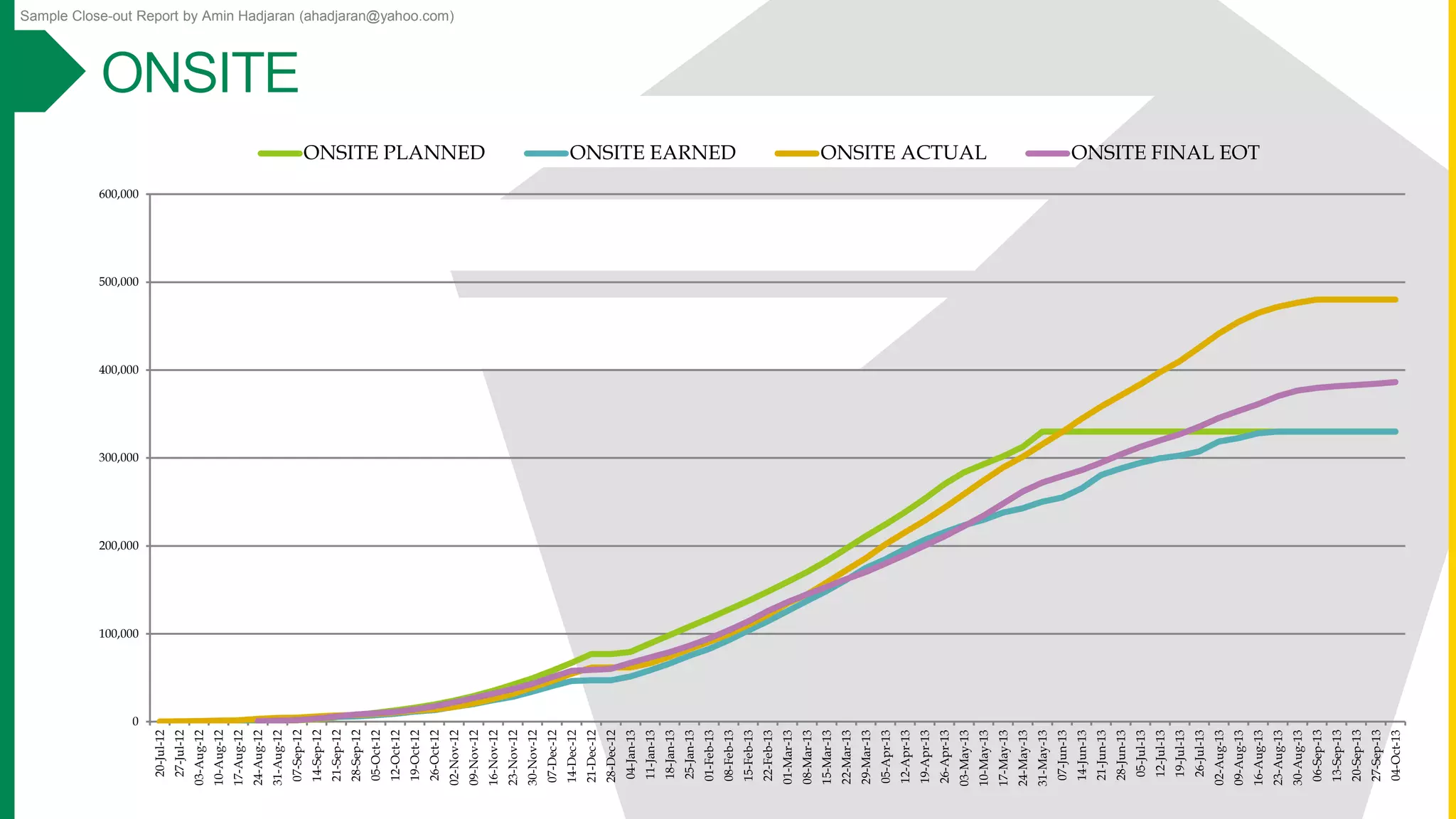

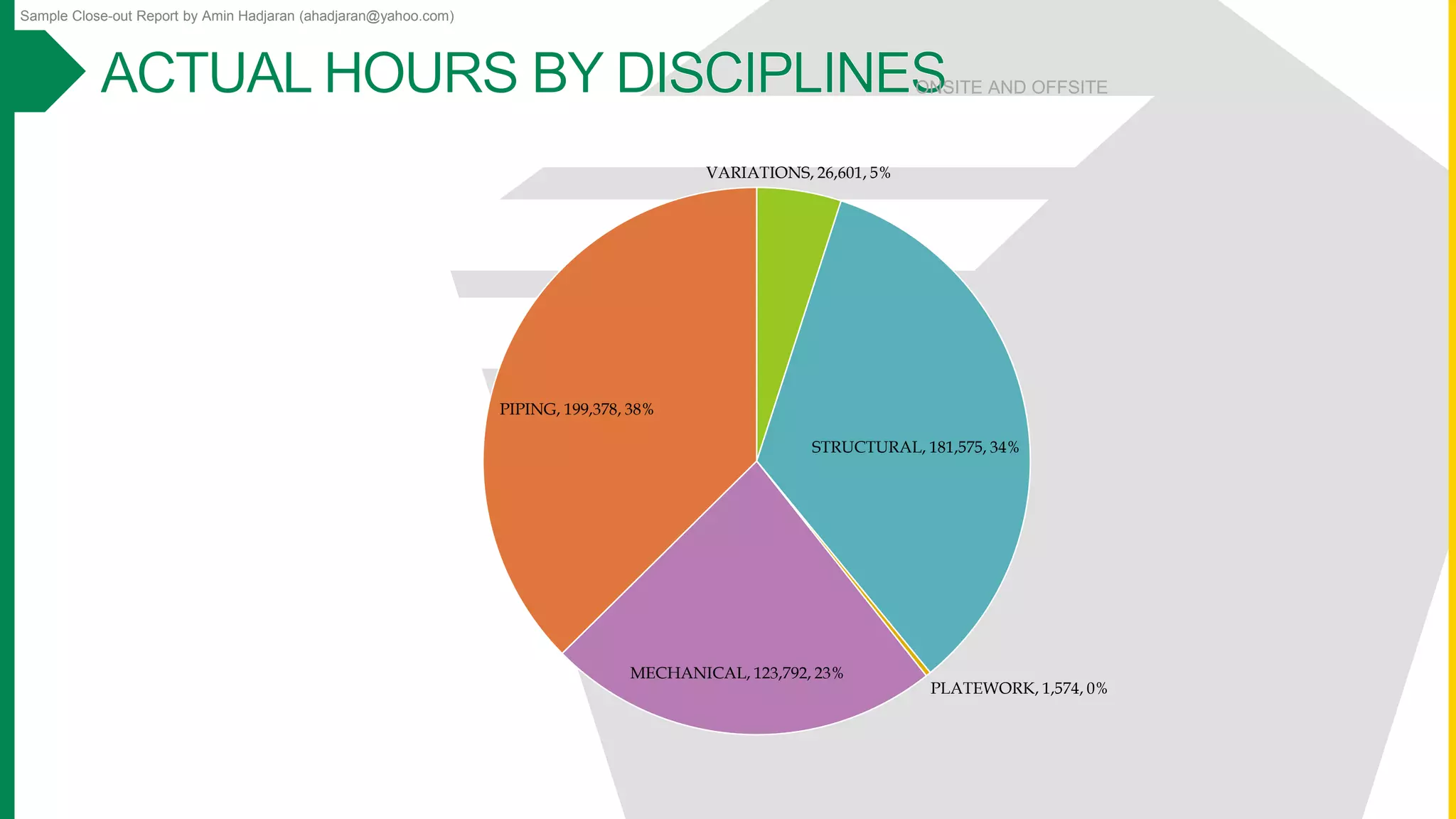

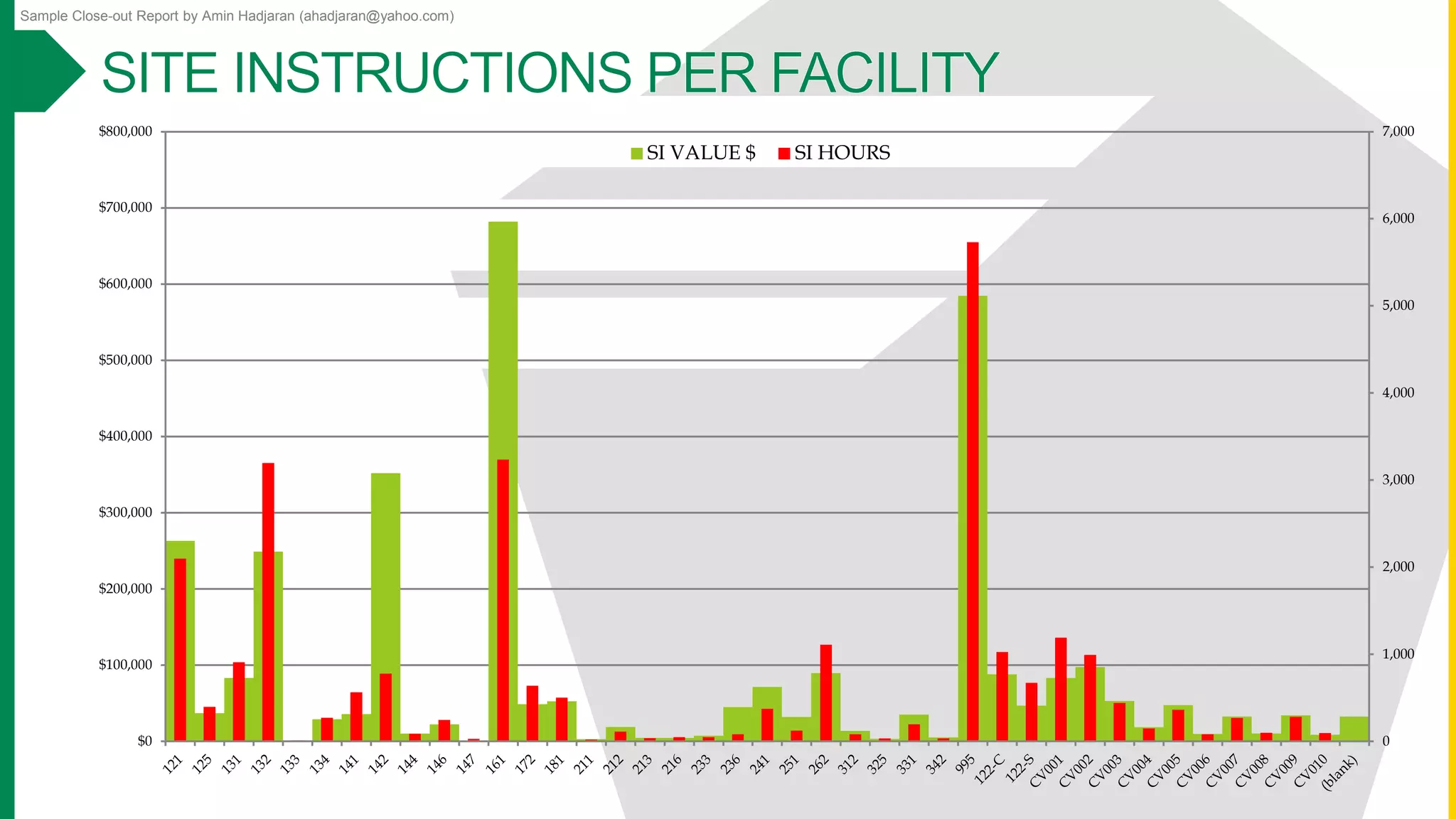

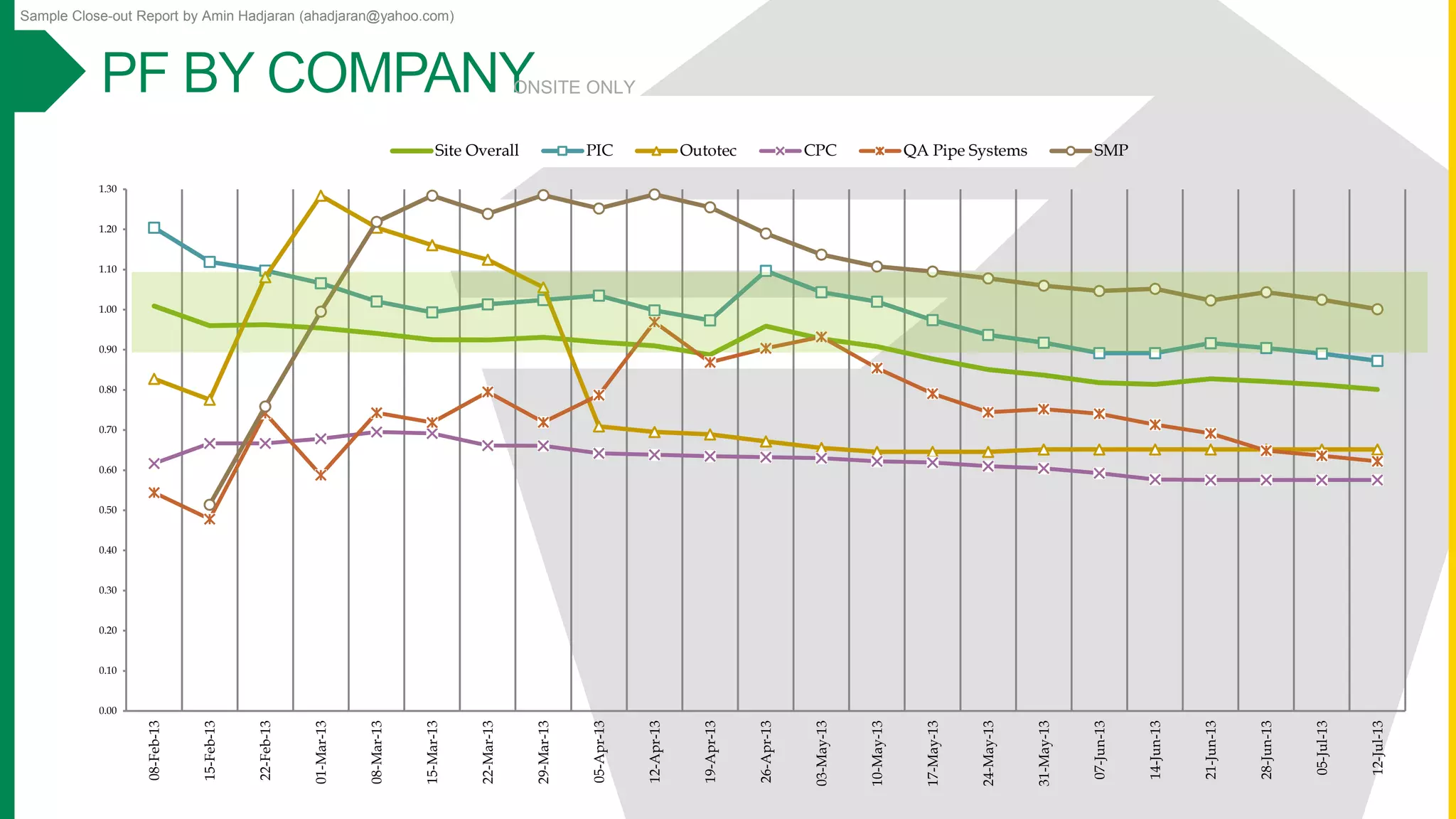

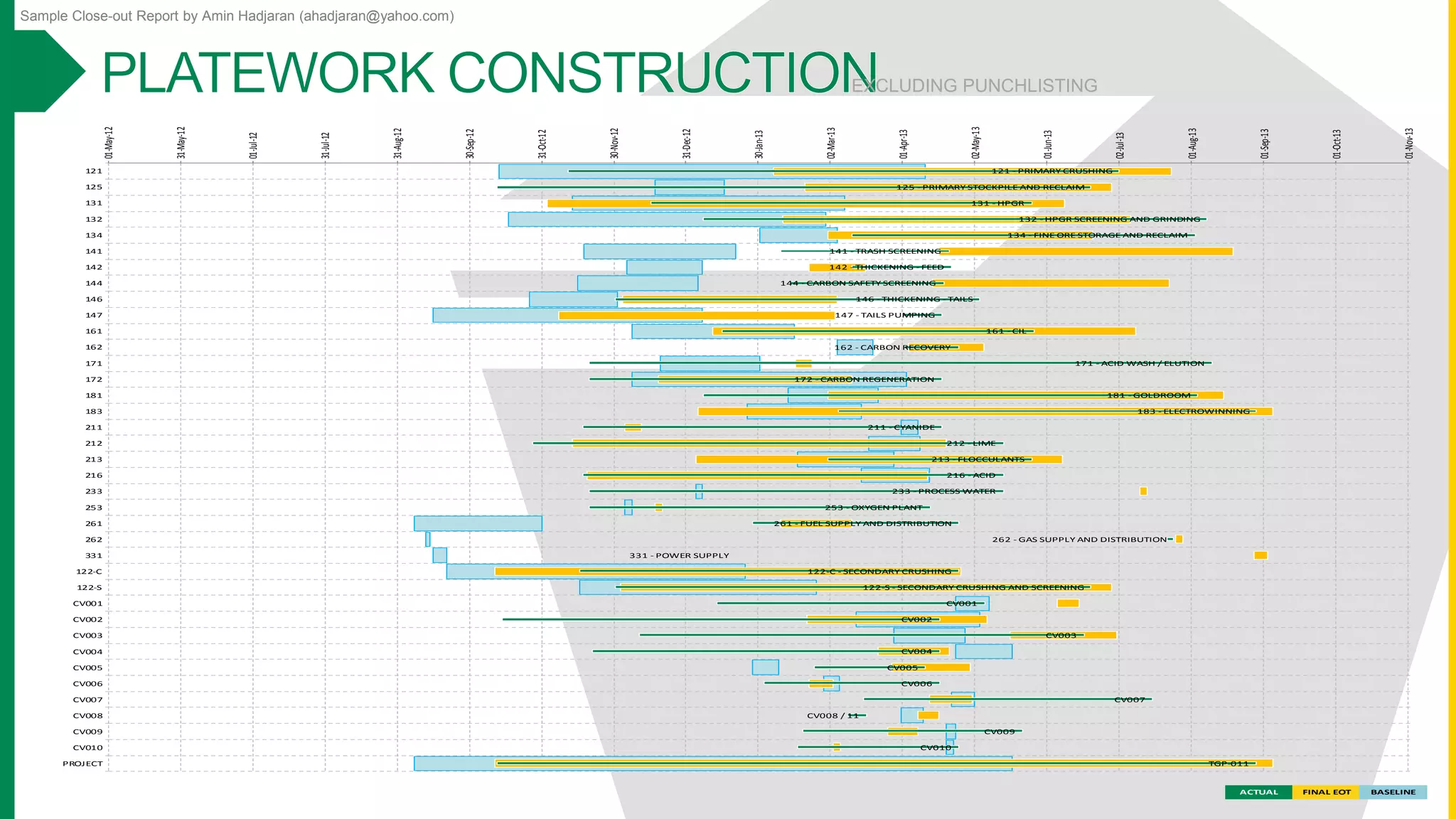

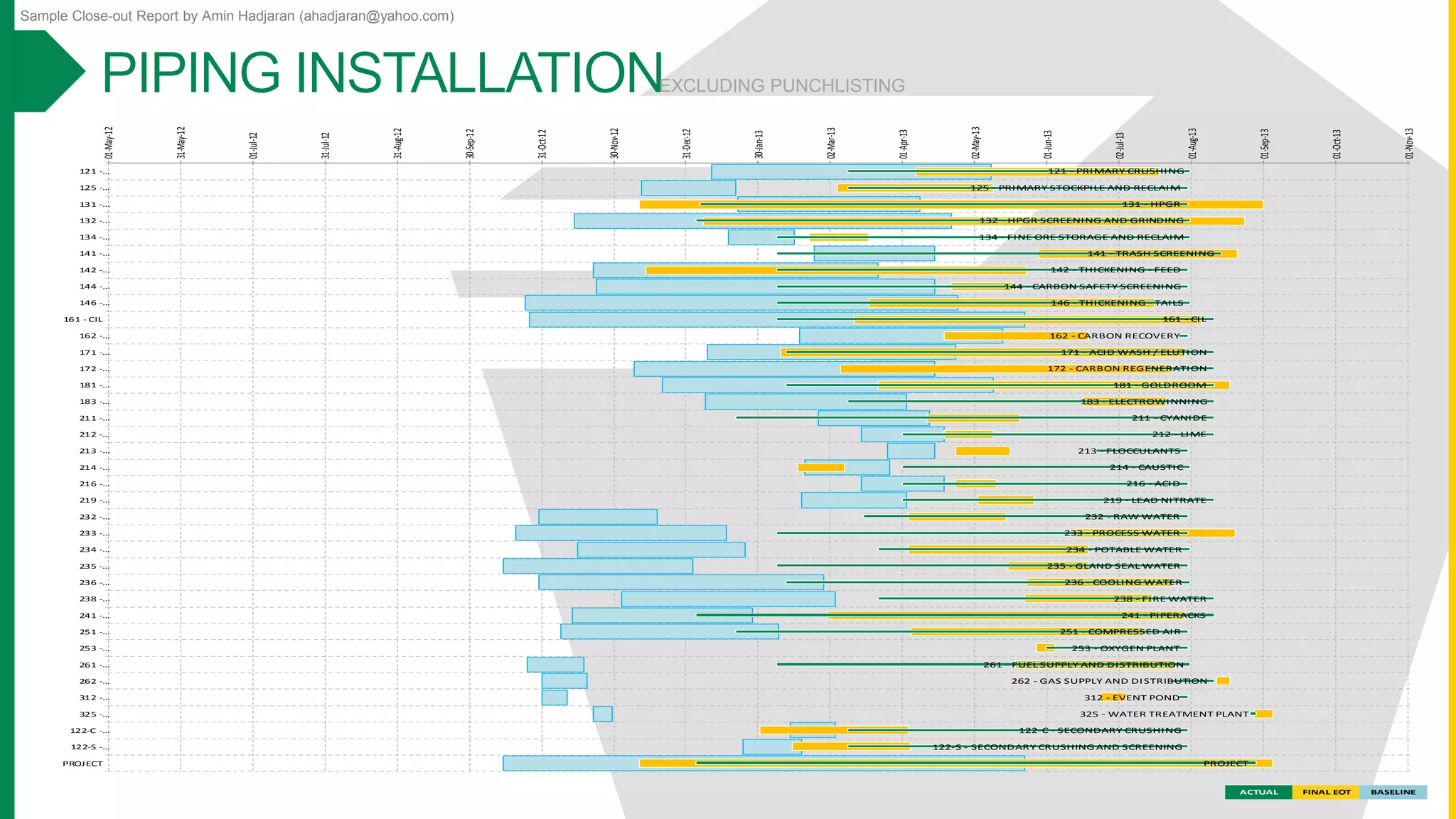

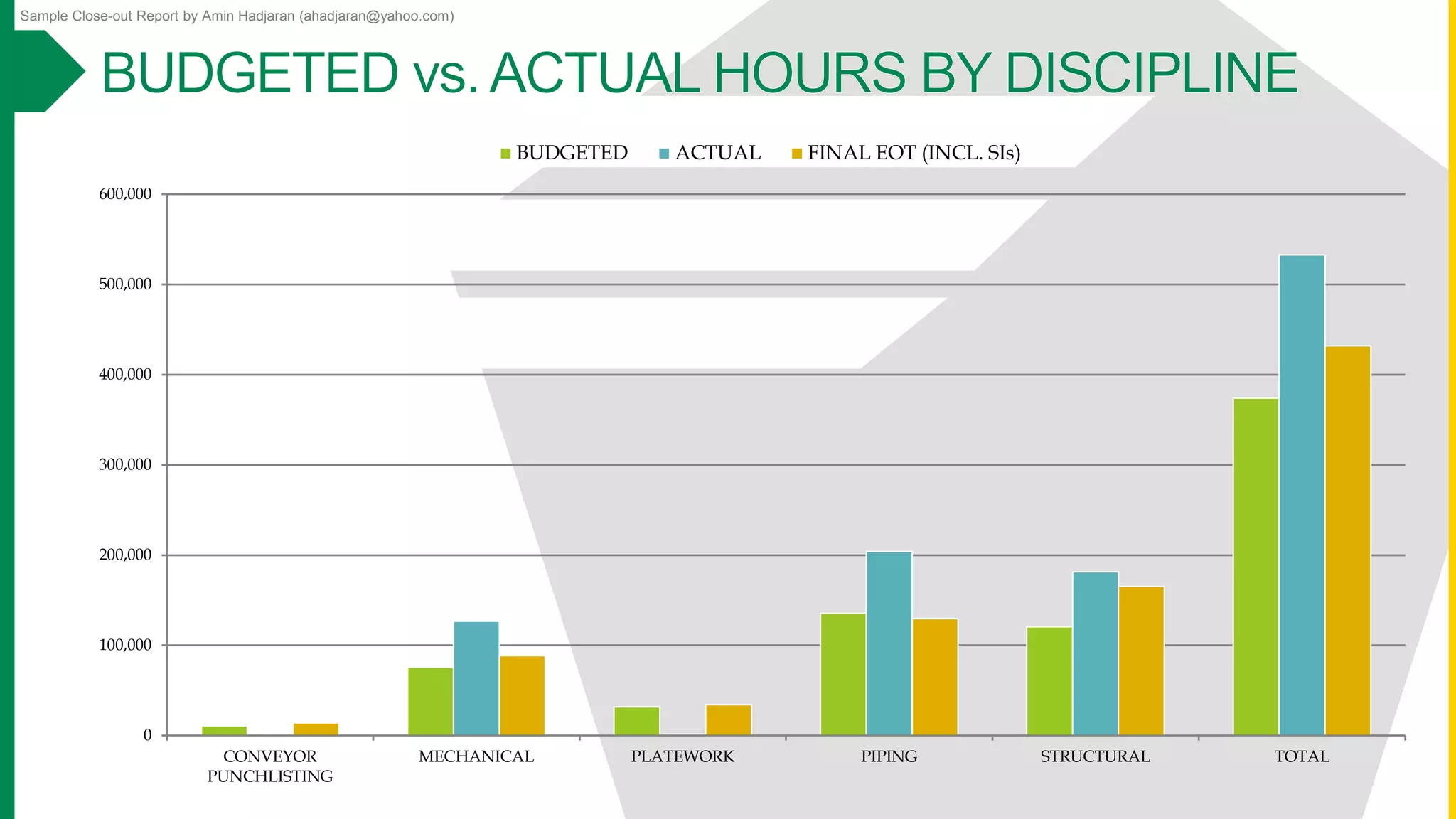

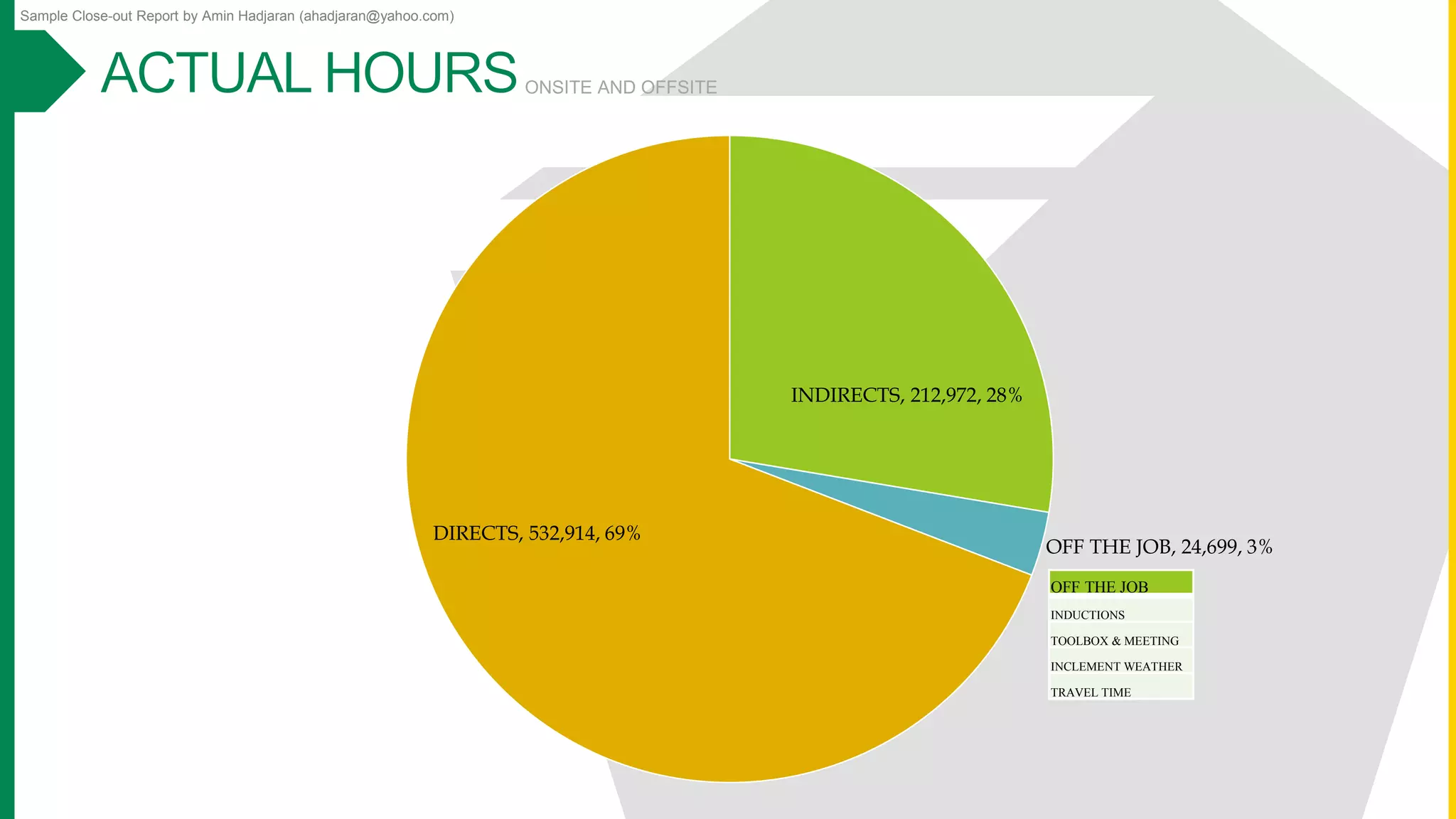

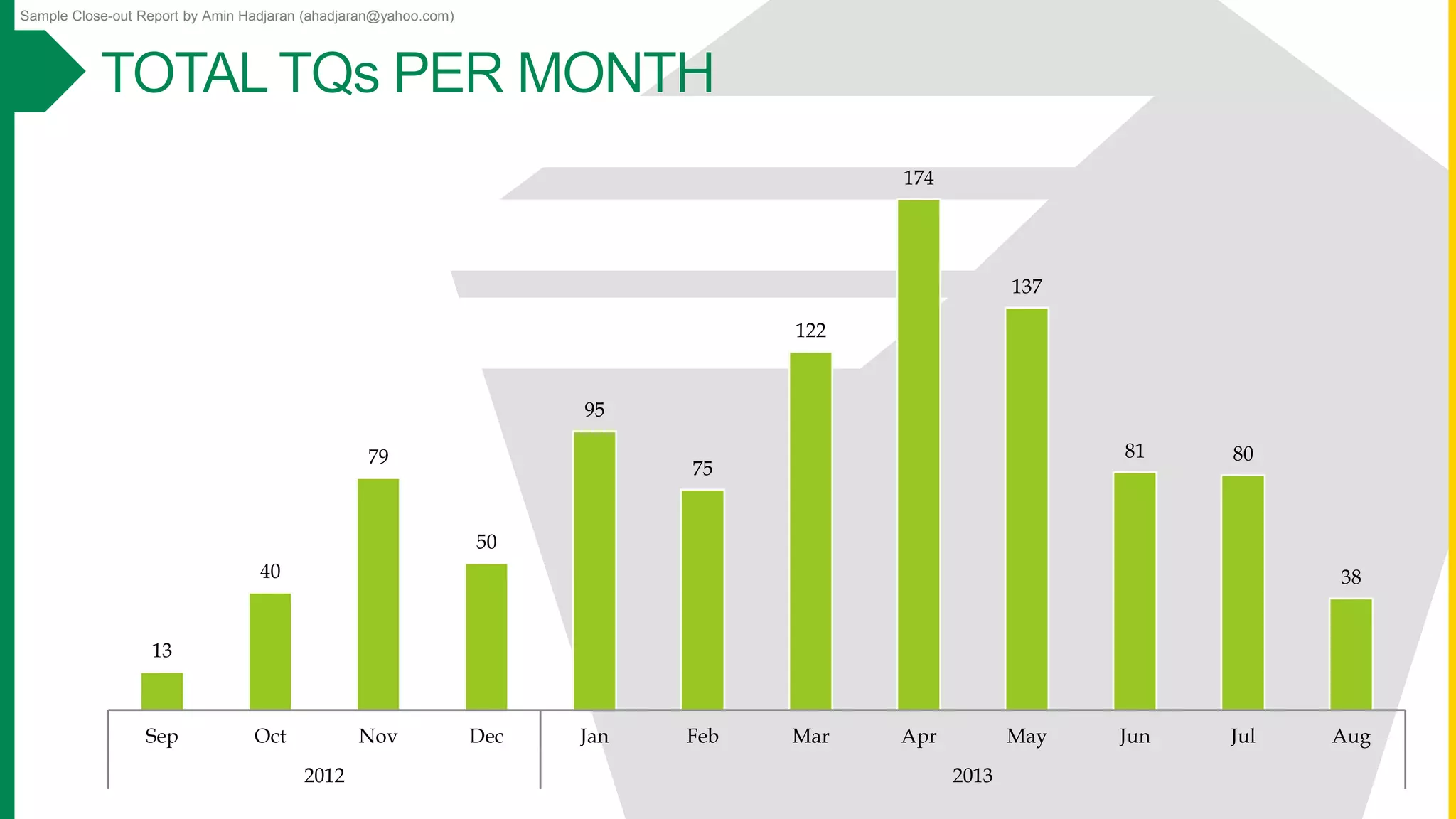

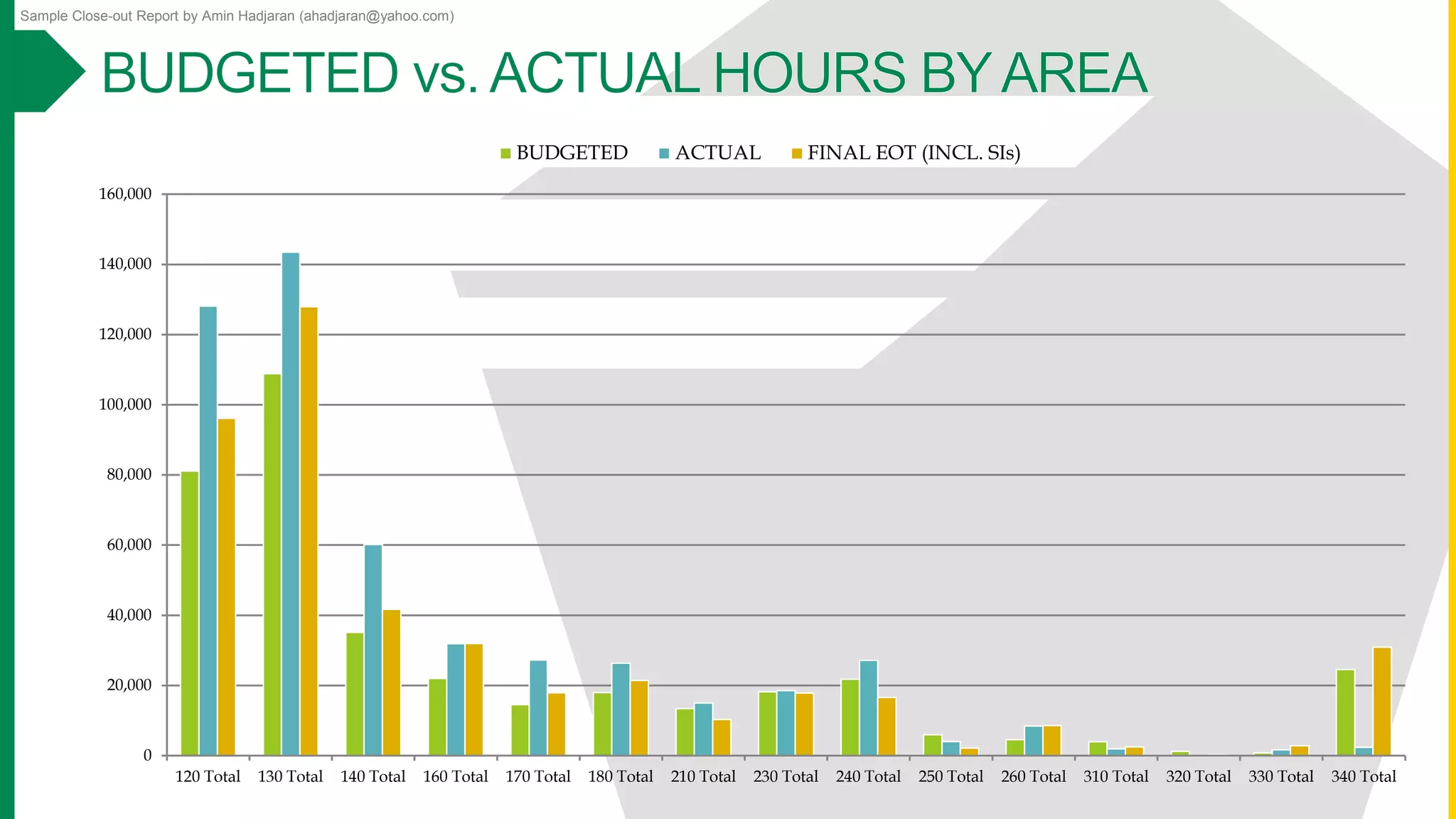

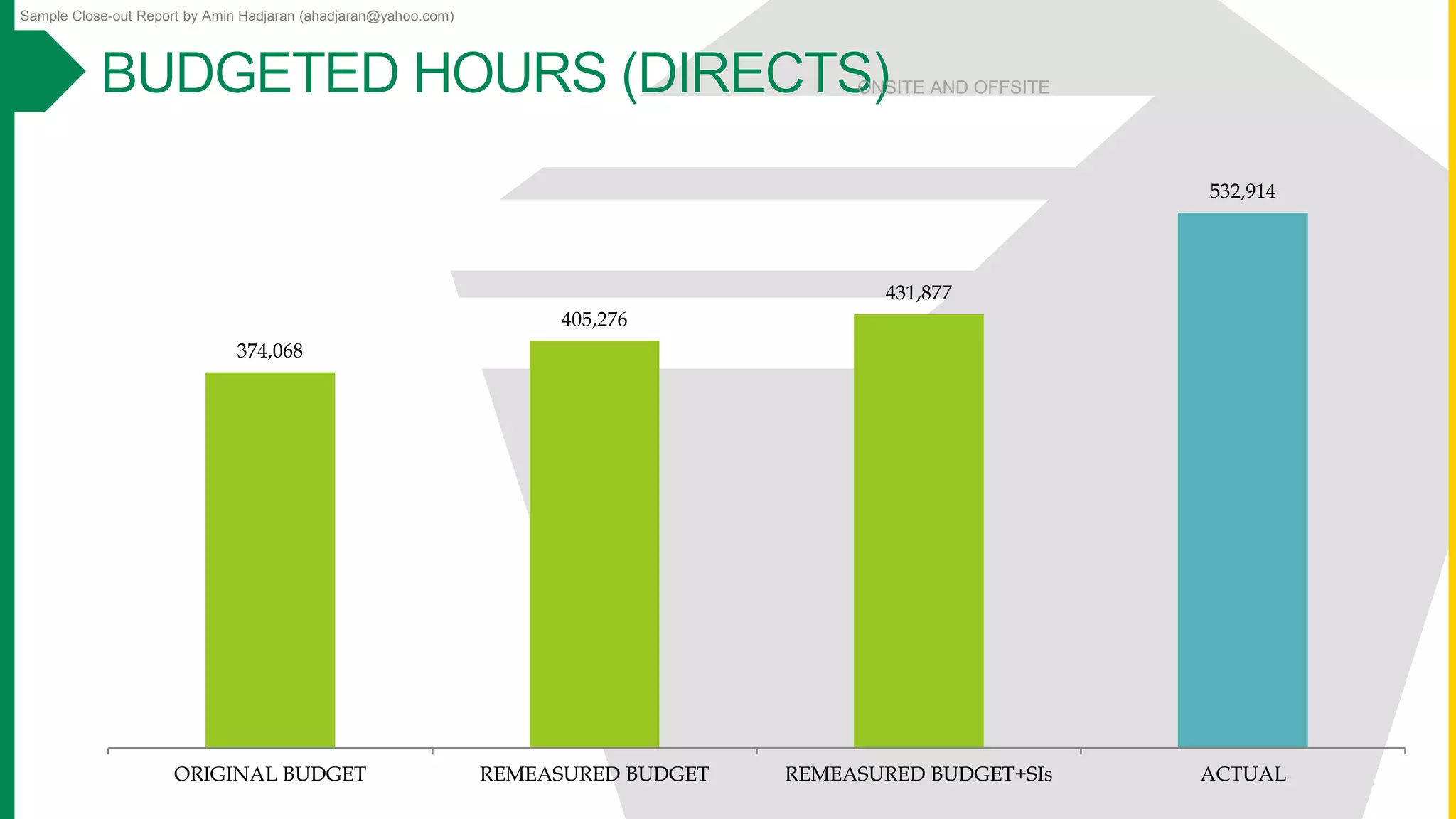

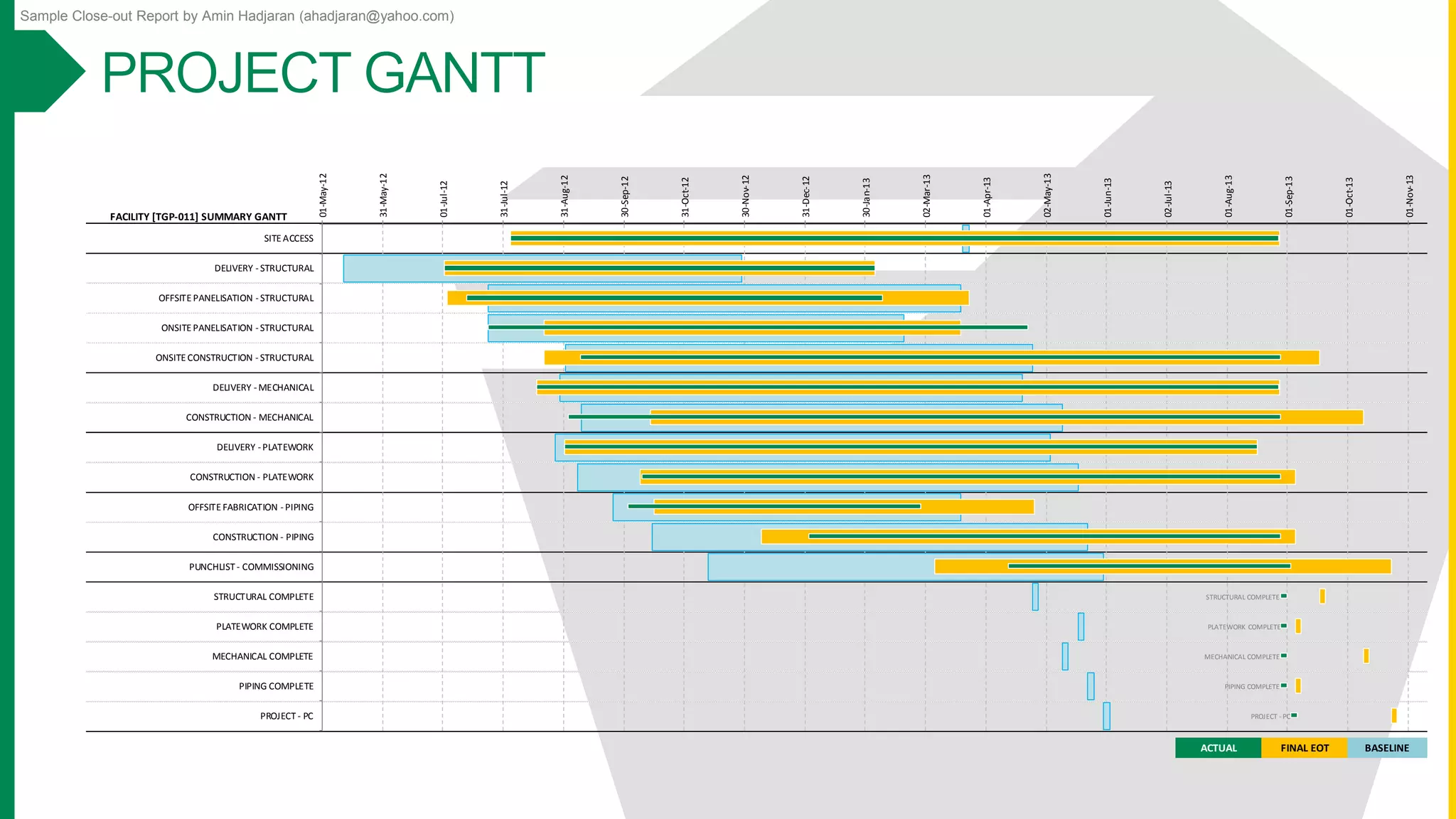

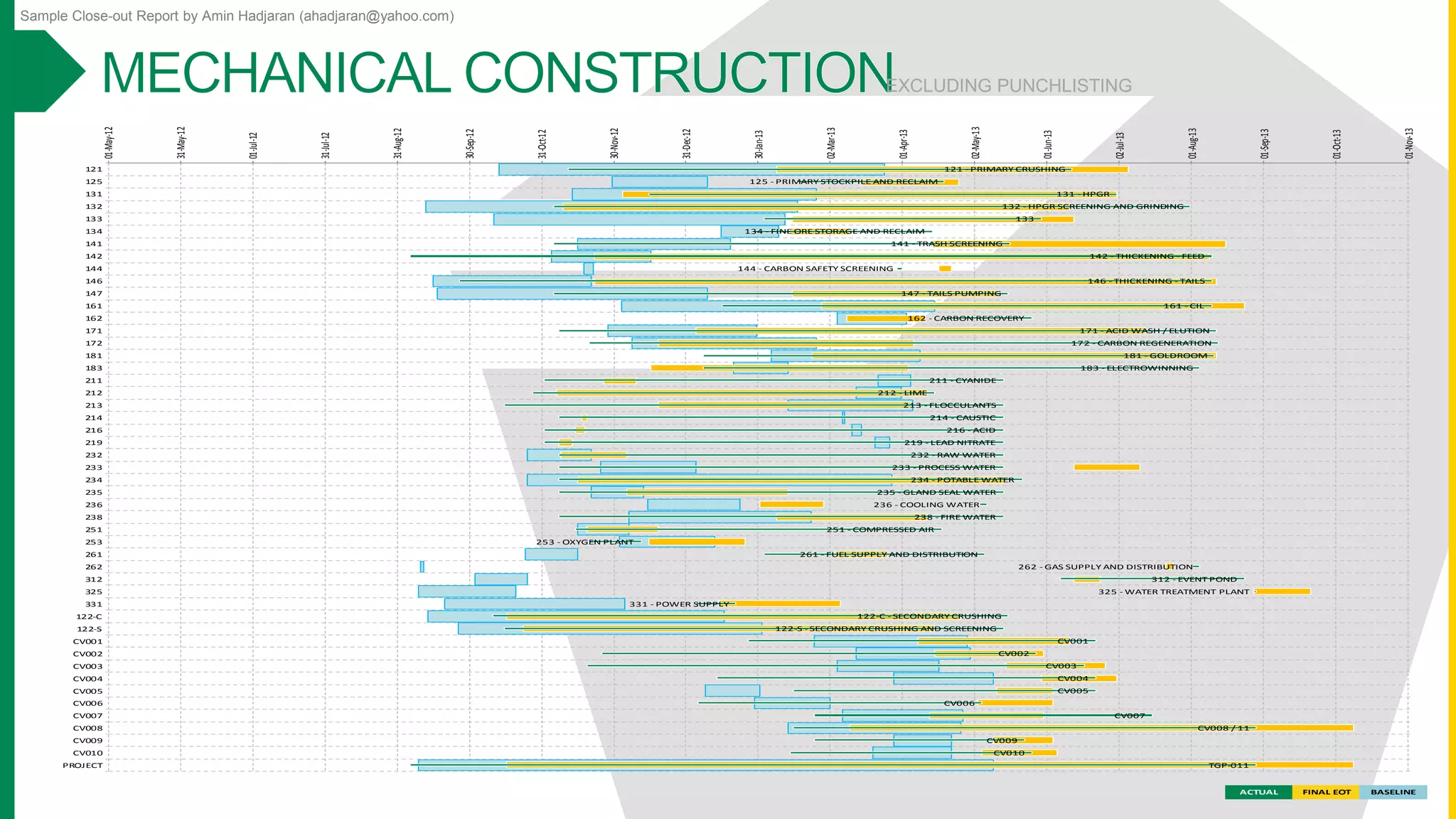

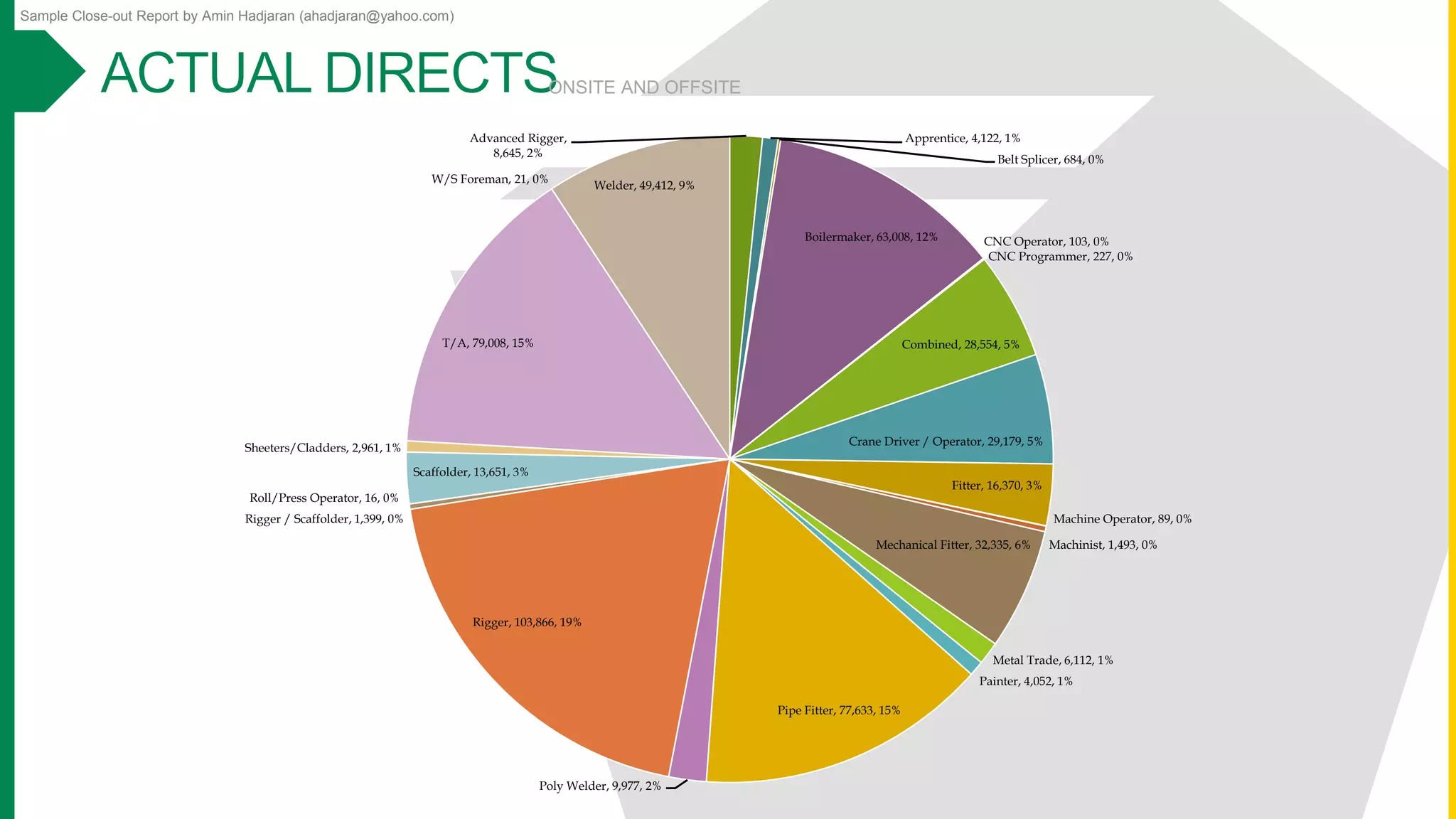

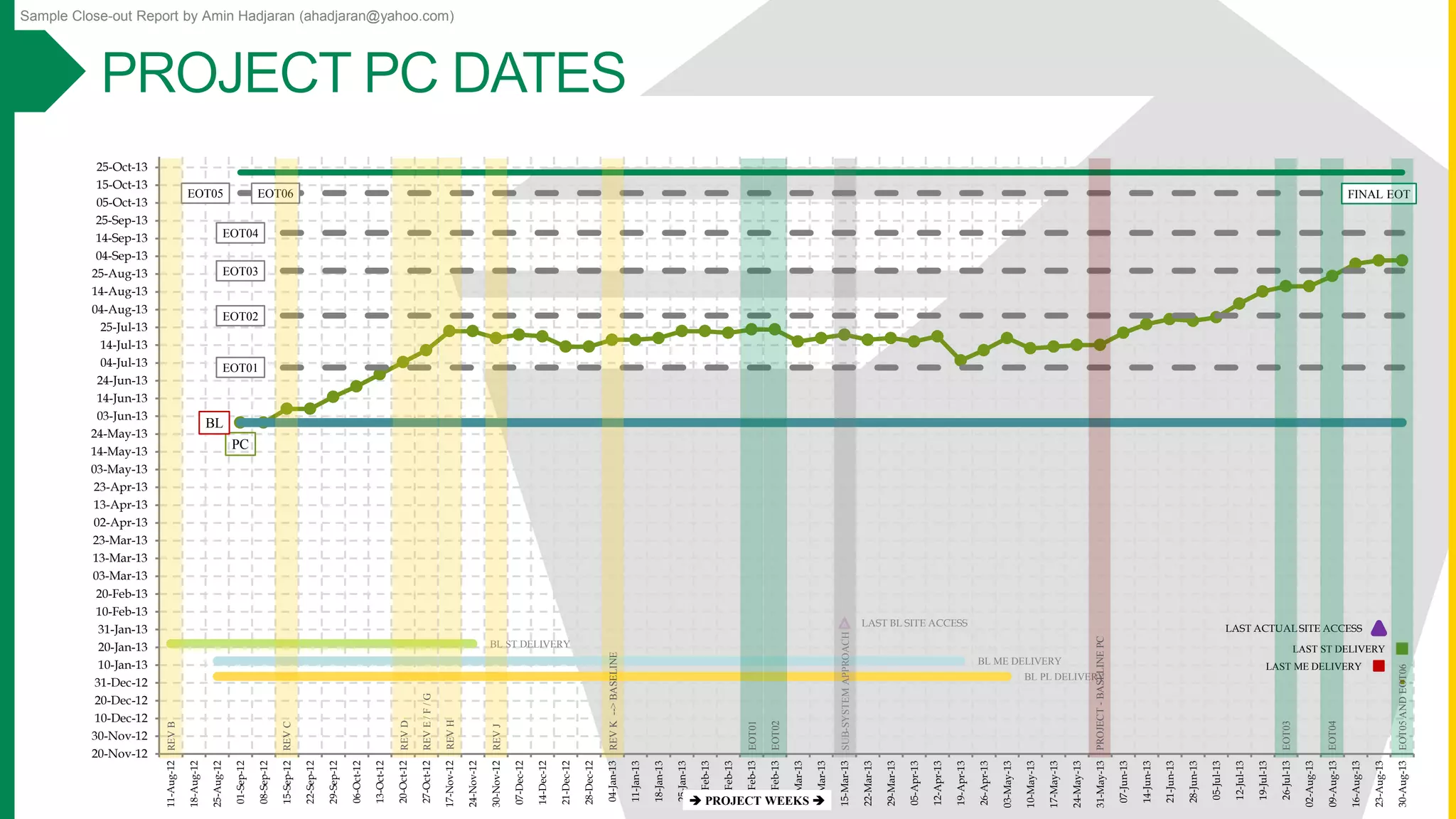

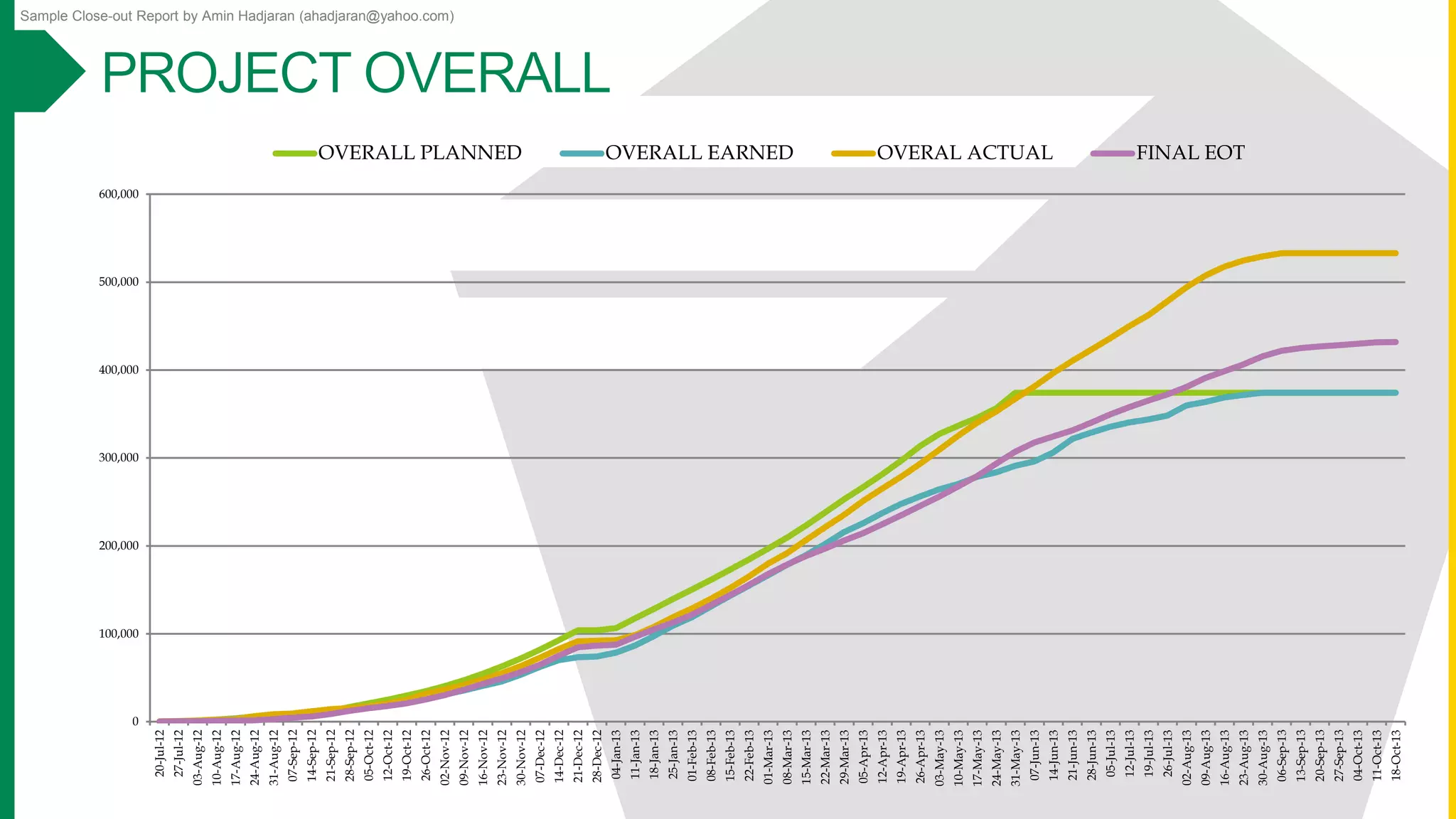

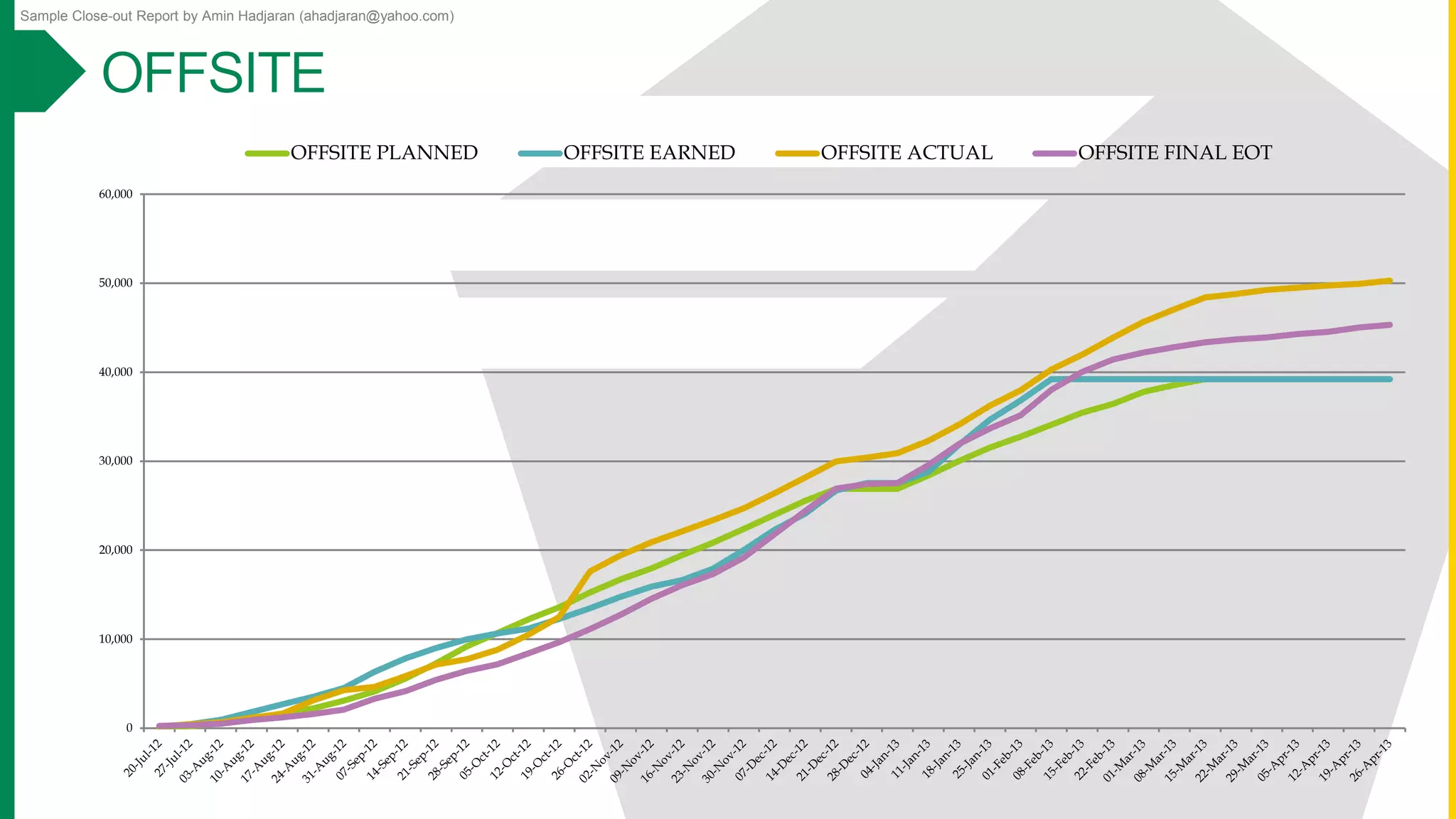

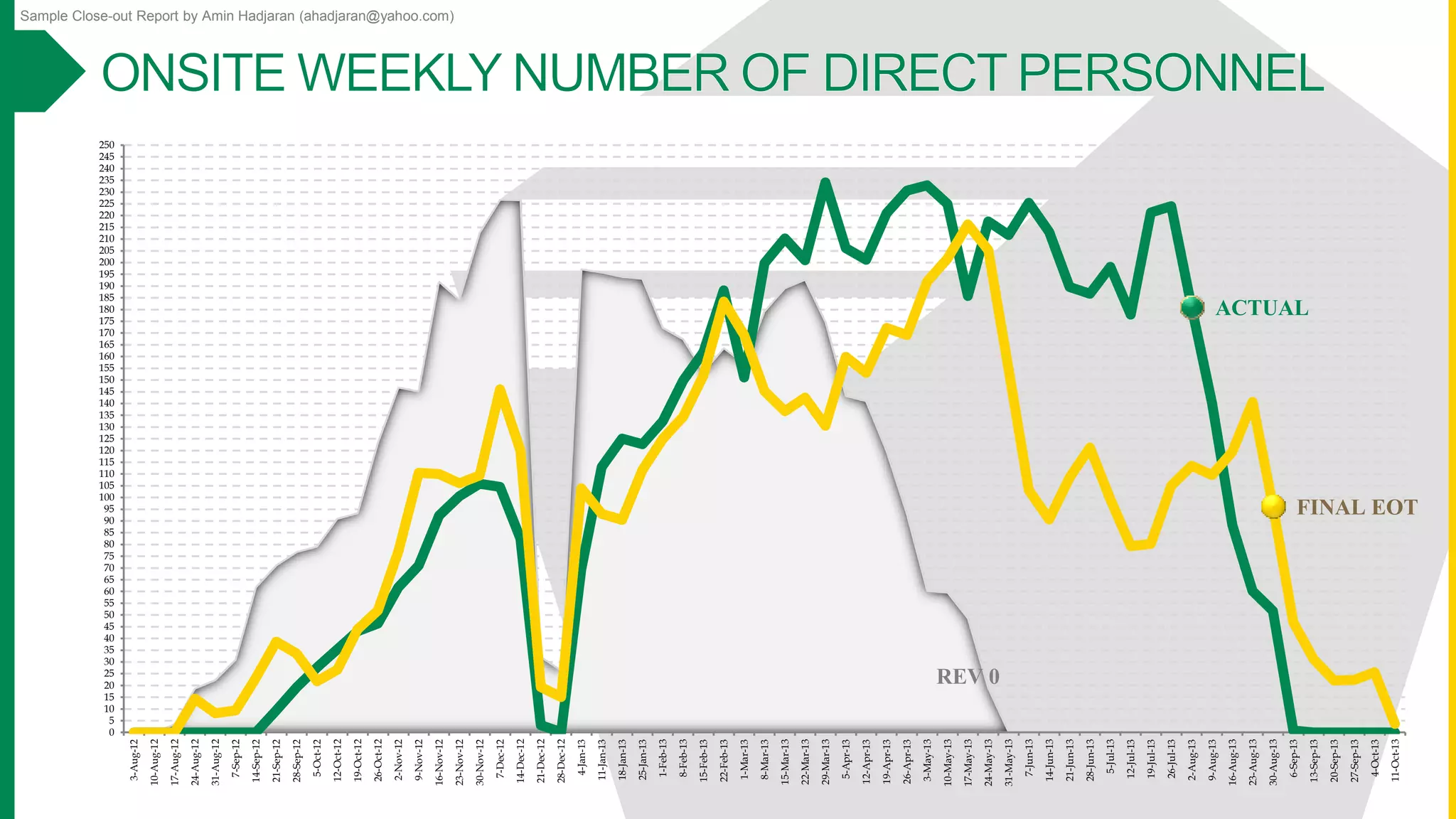

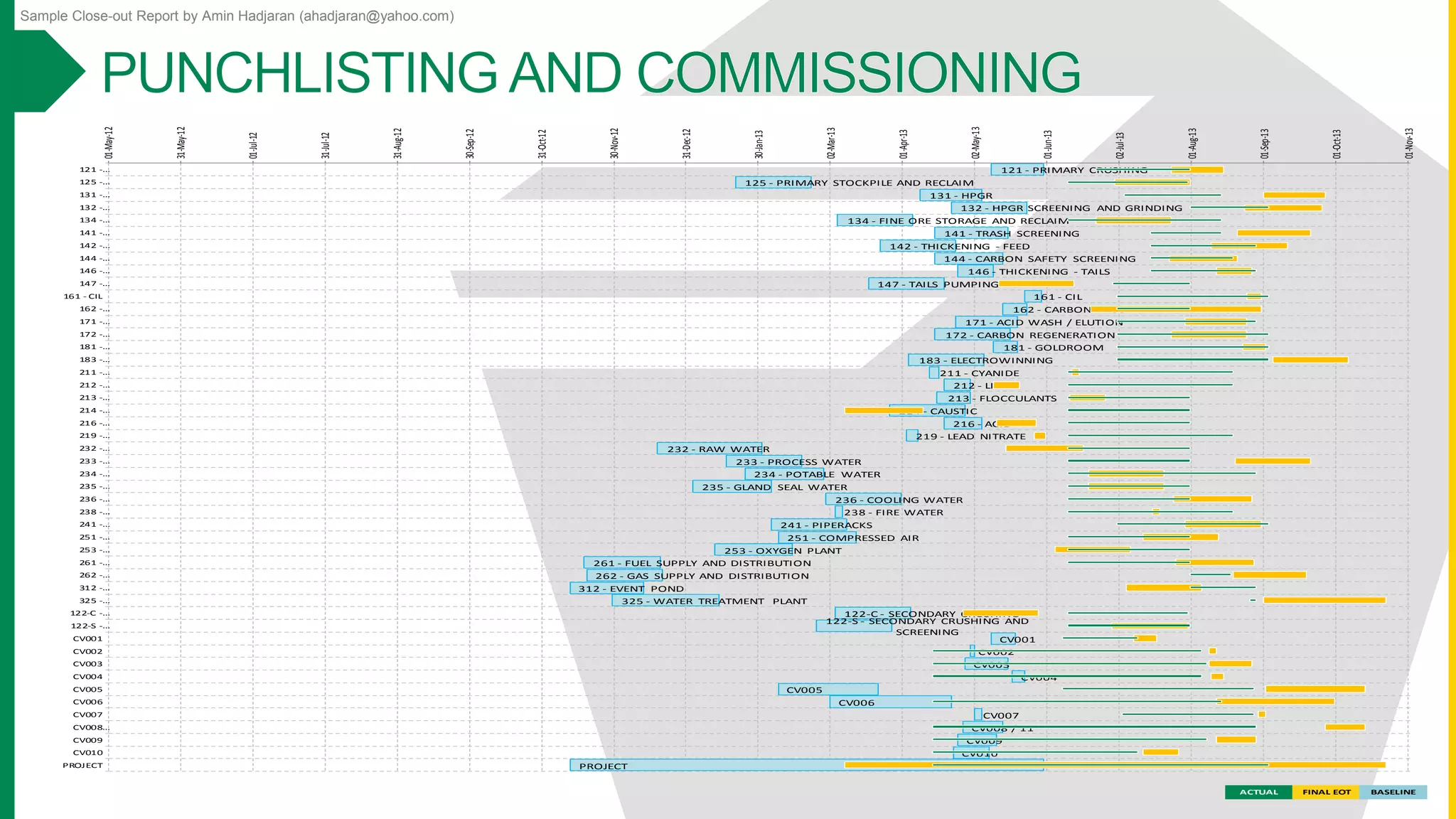

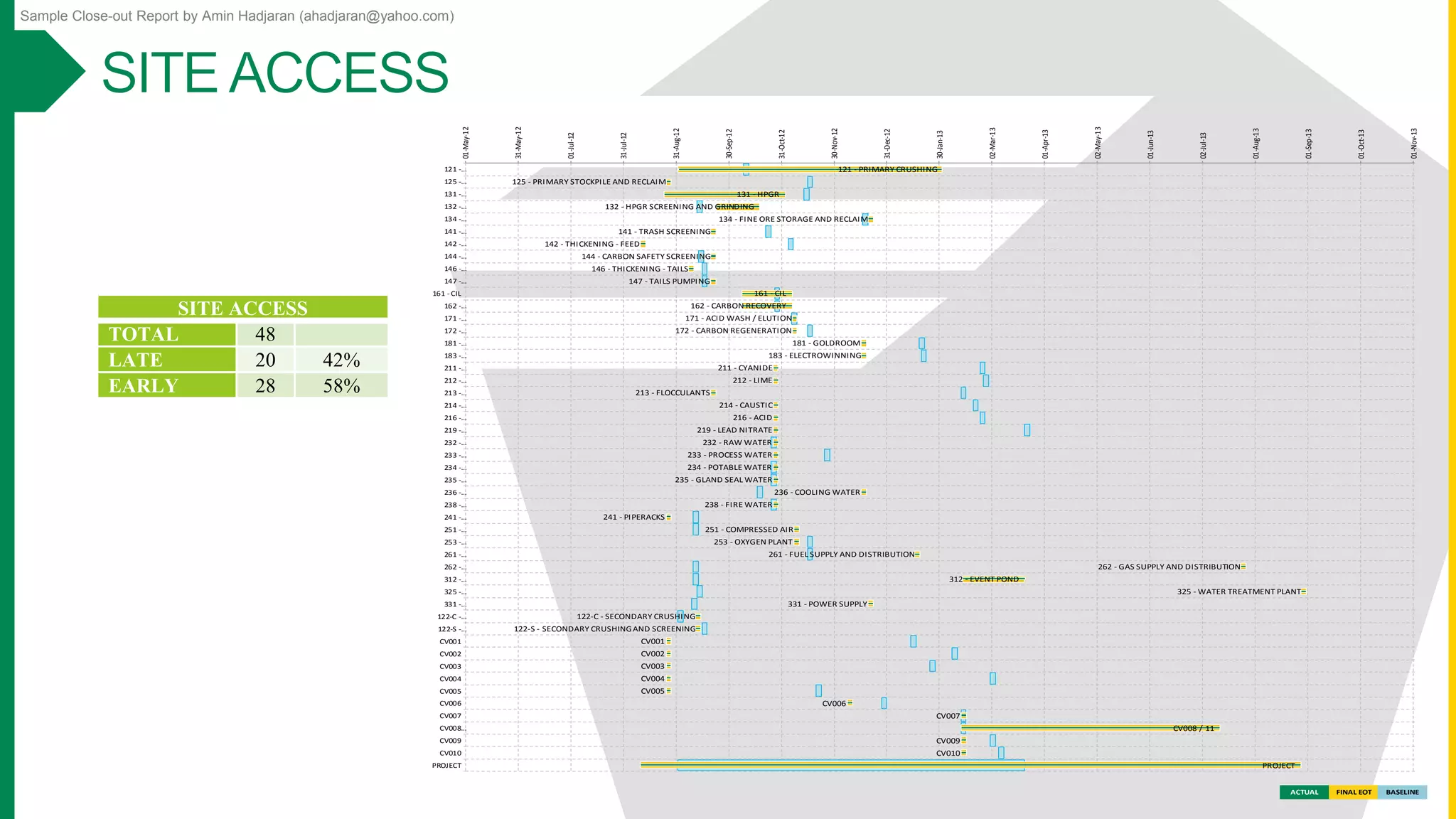

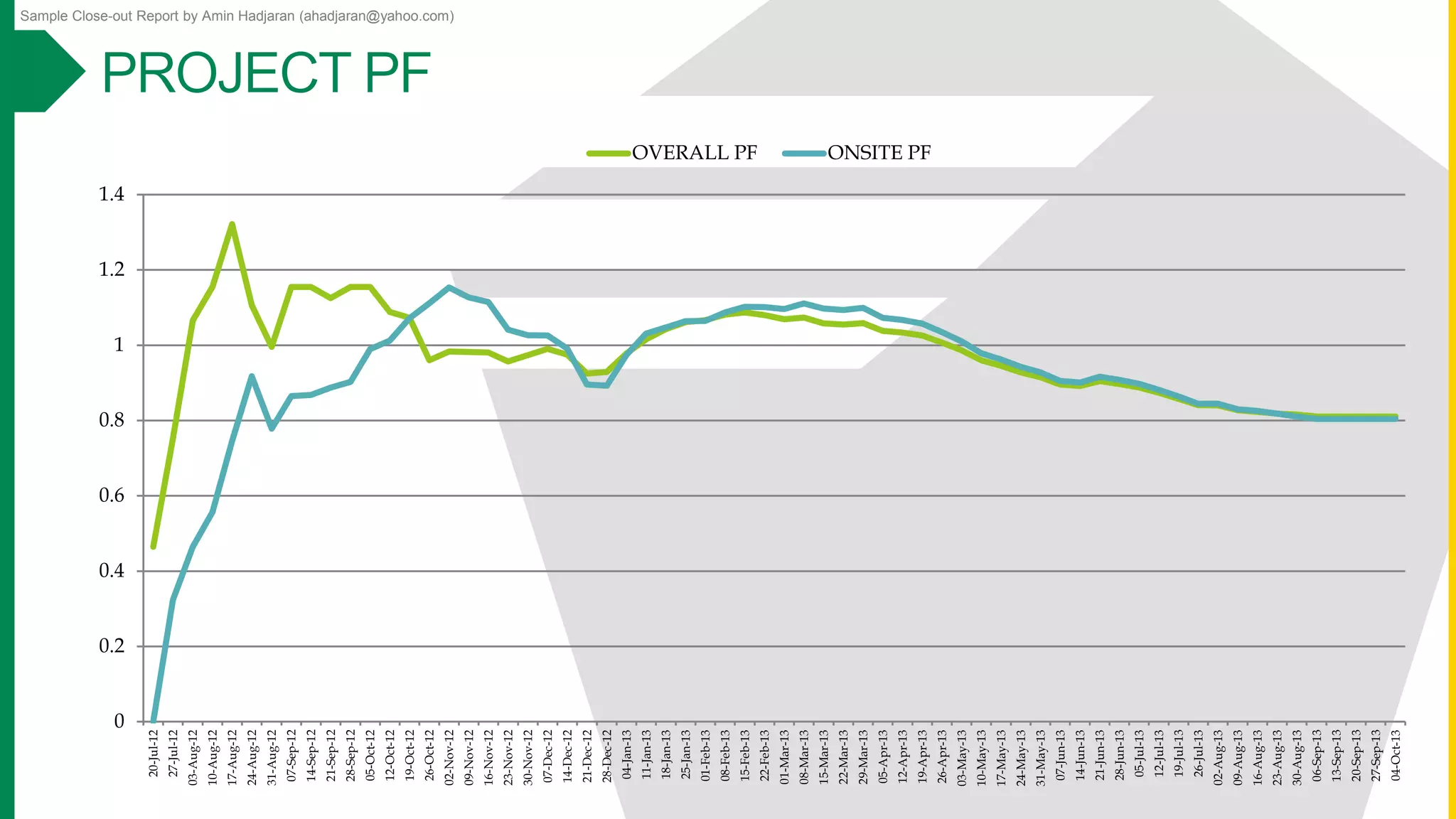

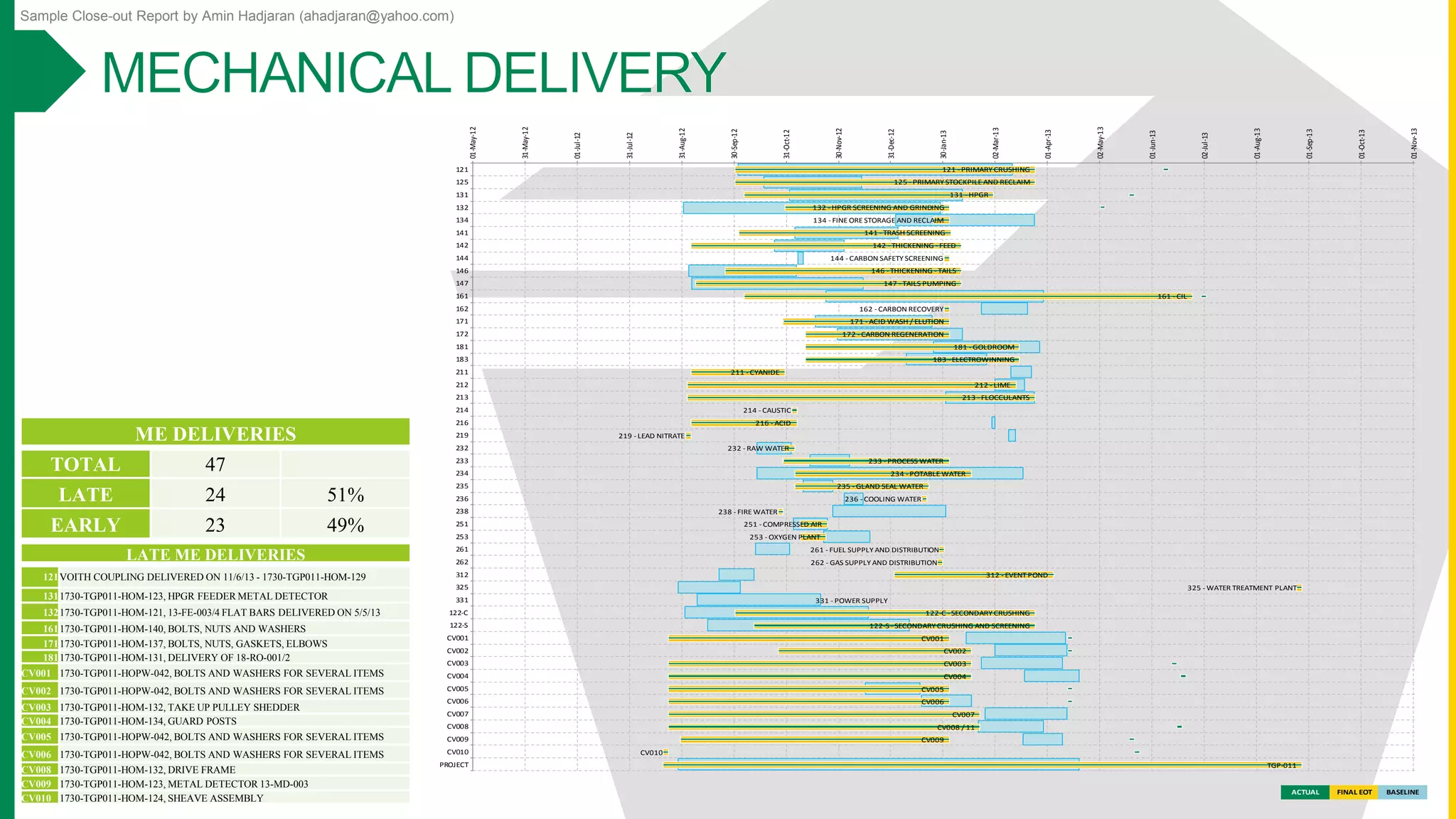

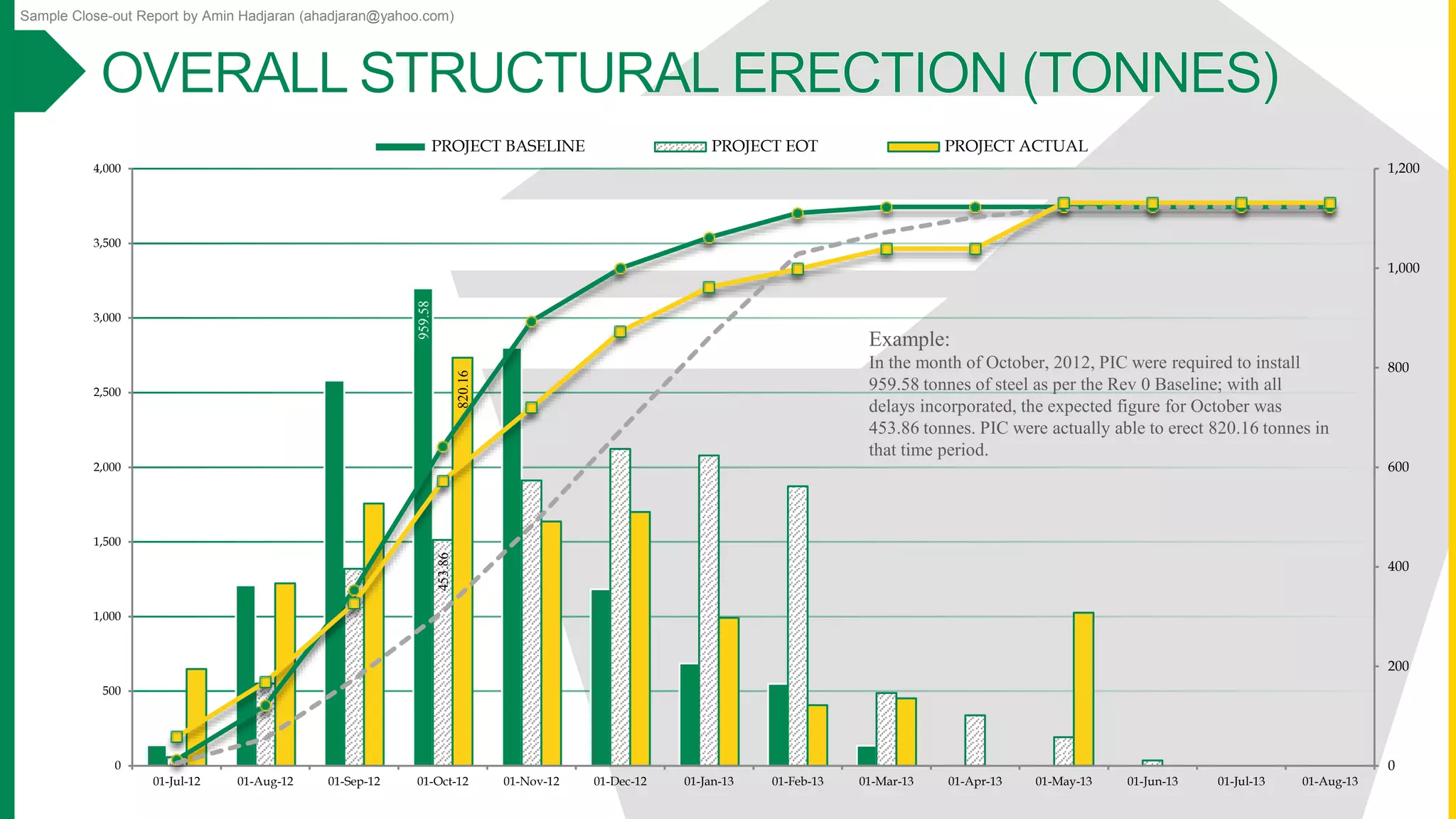

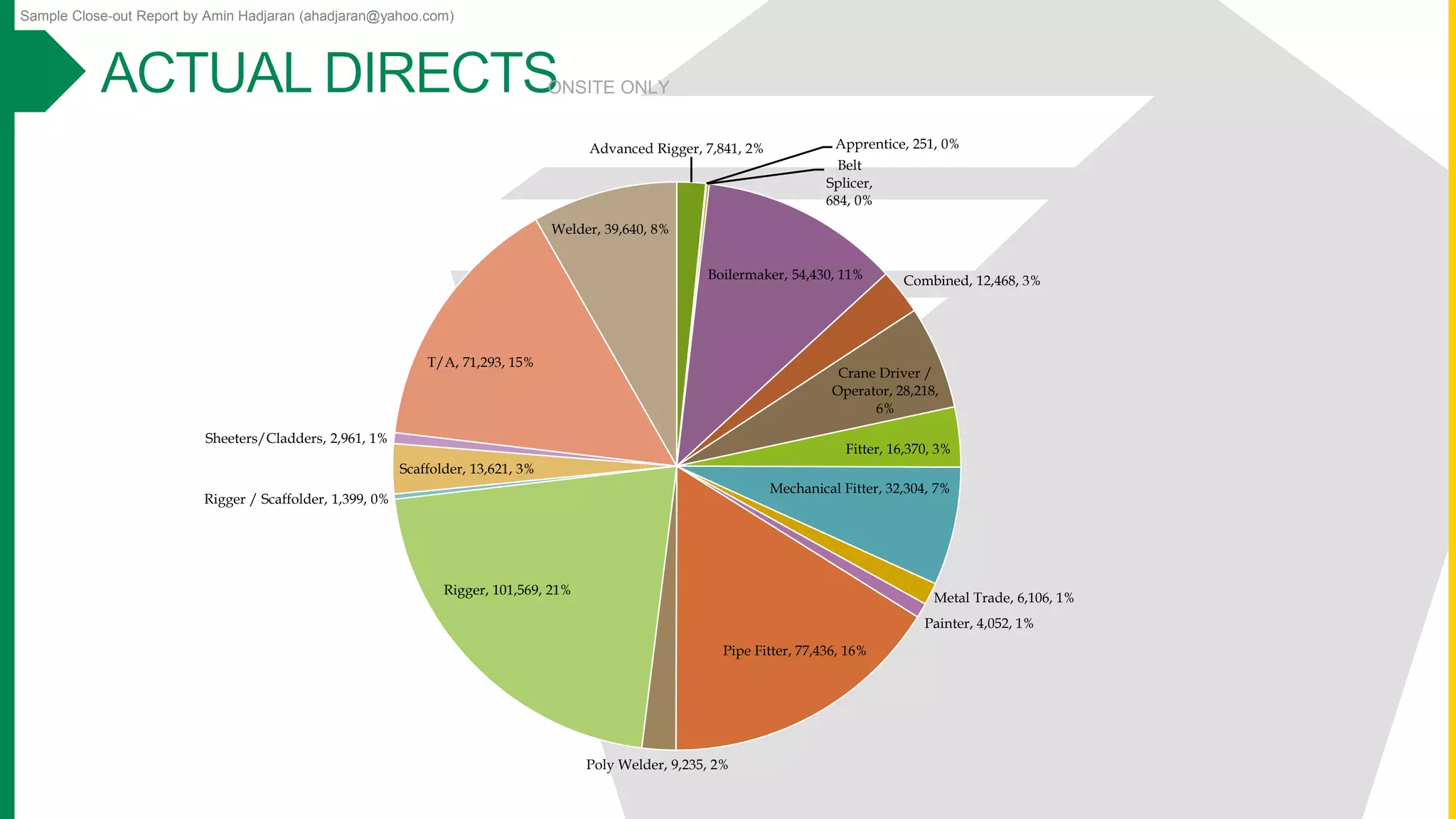

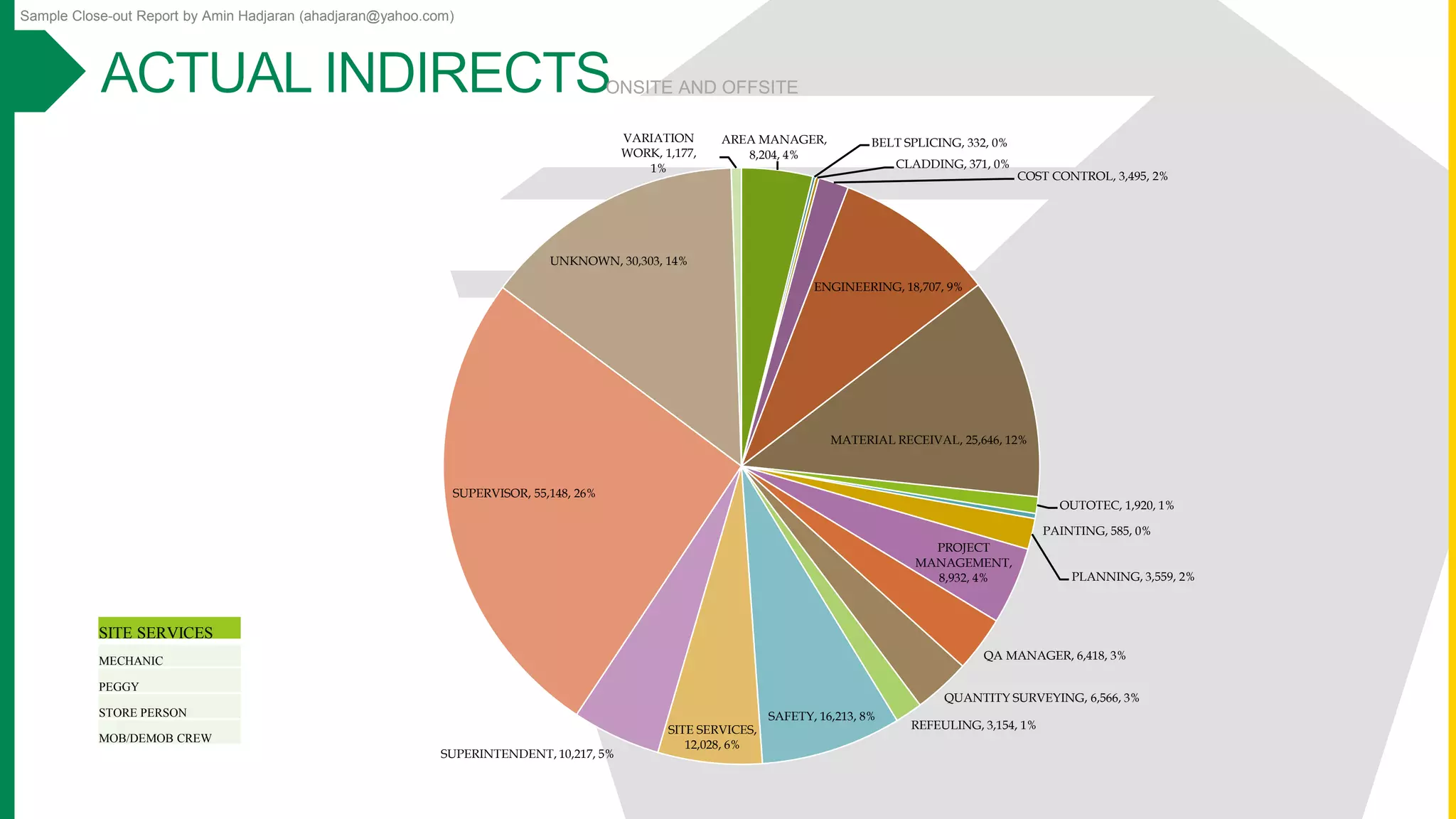

This document is a sample project close-out report prepared for an SMP EPC mining contract executed in Western Australia between 2012 and 2014. It details various project delivery performances, including steel and ME deliveries, highlighting late and early delivery percentages along with actual versus expected installation figures. The report outlines various project components ranging from primary crushing to water treatment facilities, thus providing a comprehensive overview of the project's completion status.
