Project Management Module
Professor: Helga Meyer
“PROSALO Project Management”
Submitted by
Project manager: Kritika Gill
Project Controller: Thomas Ying
Quality Manager: Syed Hassan
Systems Architect: Supanut Petrugs
Risk Manager: Camille Beauchemin
Master in International Tourism Management
International Graduate Center
Date: December 12th
2016
1
Table of Contents
1. Project manager……………………………………………………………………3
1.1 Project Strategy…………………………………………………………….3
1.2 RASCI, Team Development and escalation…………………….5
1.3 Stakeholder Management…………………………………………….6
1.4 Reflection…………………………………………………………………..…7
2. Project Controller………………………………………………………………….8
2.1 Milestone, Phases, Concept of Time Reserves……………….9
2.2 Project Cost Baseline – Challenges and Limitations……..13
2.3 Concept of Bottom up Cost Estimation………………………..15
2.4 Reflection……………………………………………………………………16
3. Quality Manager………………………………………………………………….18
3.1 Priorities……………………………………………………………………..20
3.2 Quality Assurance Plan: Required Actions……………………20
3.3 Review Plan………………………………………………………………..21
3.4 Reflection……………………………………………………………………22
4. Systems Architect………………………………………………………………..24
4.1 Use cases…………………………………………………………………….25
4.2 Requirements Definition…………………………………………….28
4.3 Plan for Verification and Validation…………………………….29
4.4 Reflection …………………………………………………………………..30
5. Risk Manager………………………………………………………………………32
5.1 Risk Description………………………………………………………….34
5.2 Risk Evaluation and Portfolio………………………………………34
5.3 Risk Strategy and Mitigation Plan……………………………….36
5.4 Reflection……………………………………………………………………38
2
Table of Contents
1. Introduction
Background
Objectives
2. Role and Responsibilities of a Project Manager
3. Skills of a Project Manager
4. RASCI
5. Team Development
6. Escalations
7. Stakeholder Management
8. Reflection
References
3
Project Prosalo
1. Introduction
Background
The most important role in the project is that of a Project Manager and the roles and responsibilities
he has to make a project successful. As he is responsible for overall management of the project, he is
the sole person accountable to produce the end result. It is paramount to understand how the
project manager interlinks and allocates the responsibilities to work towards one common goal.
Research Objectives
This paper is focused on the strategy used in the Project Prosalo, how the team was developed and
various stages of team development. The usage of the RASCI method to assign responsibilities to
have more clear objectives by each team member. Also, In depth understanding of the roles of the
project manager and how he contributes to have a successful project.
2. Roles and Responsibilities of the Project Manager
Project Managers are change agents: they make project goals their own and use their skills and
expertise to inspire a sense of shared purpose within the project team (PMI). He is responsible for
Initiation, planning, execution, monitoring, controlling and closure of the project.
In the Initiation phase of Project Prosalo a detailed project charter was prepared. Apart from this the
background of the Project which is the need to set up an office in Brussels along with benefits is
mentioned which in case of Prosalo is staying closer to the changing trends of the European Market.
The Charter has a clear and focused Mission statement and also the Exclusions, Budget of the Project
to give a complete overview of the project.
Planning
It is imperative for the project manager to clearly define and clarify the scope of the project, project
plan and policies and procedures to be followed during project. During the planning phase of prosalo,
the vision was set in which clear objectives of the project were laid and the strategy of the project
was thought of which will be implemented to achieve the goals. Also, a finished plan was prepared
which describes what should have been achieved at the end of the project. Most favorable road map
was selected which clearly describes the aims. In the planning phase the following was decided:
 Scope of the Project: The Boundaries of the project were decided upon. The major
objectives, tasks, goal, time and deliverables were established.
 Work Breakdown Structure: The work structure will be planned in detail keeping each
activity in mind and was designed into manageable sections. It is basically an outline of the
entire project is designed keeping in mind major functional deliverables. This will eventually
help the team to follow an organized work pattern. The team will make milestones and
4
schedules that indicate the change of phases and the events to control and analyze the
progress of the project. This will also help the team to recognize the accomplishments.
 Scheduling: In this segment, a critical path to finish the project was chosen and also the free
slack will be decided upon.
 Risk Assessment: Projects are always future oriented, which means they are subject to
unforeseeable problems or risks. (Roland Ottmann, 2012, p.143) It is vital for a successful
project to identify any possible risks that might affect the project. After careful evaluation
with the team, customers and end users associated risks will be identified and the impacts it
could have on the project and impact matrix was prepared and the strategy options will be
decided upon to minimize or deal with the risk in the most effective way.
 Stakeholder Management: All possible stakeholders will be identified and understood and
according to their power and interest in the project and how they will managed to ensure no
delays in the progress of the project.
 Closing project Plan: This will be prepared to finalize all completed activities of the project to
formally close the project. To ensure completion and identify the best practices and lessons
for any future projects.
Organizing, Monitoring and controlling
The structure of the team will be set which will meet the needs at different stages of the project.
Assigning responsibilities and authority to various team members various tasks. Also, leaders in the
group will be designated power and responsibility who will be accountable for the tasks of their team
and will report directly to the Project manager in case of any escalations. The progress will be tracked
the progress of the project and monitor the progress of the assigned tasks and communicate same
effectively to the team and management. Also, measuring team performance through
reports ,documentation and assessing timelines and budget are needed to be controlled by the
project manager.
3. Skills of the Project Manager
Project Manager plays the most important role as he directs the entire operation. He has many
responsibilities, from directing and maintaining the project plans to make reports of the performance
of the project. He plays as a mentor to his entire team in terms of proving any sort of consultation in
the team. He is the mediator between the sponsor and his team. He along with his team decides and
plan the kind of resources required for the project. The organizer of the entire team and a negotiator
to get the resources required for the project. The project manager also plays a role of a diplomat to
make connections with the stakeholders and many others who are in anyway affecting the project to
get their support. Apart from all of the above, it is vital for a project manager to have leadership
ability. He creates the vision for the team and provides guidance in a participative style. Also, he
needs to be appreciative and value the contributions of every team and should be a source of
encouragement and motivation. In addition to all this, he needs to build an environment of trust and
enjoyment so that the tasks do not become mundane for the team members. A capable project
manager provides opportunity for learning and development by encouraging individuals to assume
the initiative, take risks, and make decisions.( Clements/Gido, 2009, p.307). People, who are less
experienced, learn from others and develop more skills at the end of the project. As project
5
managers need to communicate effectively to their team it is imperative that they are good
communicators. They should know how to share the information in a variety of ways. Also as they
are the mediator between management and also have to prepare frequent reports.
4. RASCI
This responsibility Matrix Structure in Project Prosalo has been used to assign tasks or deliverables
to each role in the team. As there are four levels of accountability, Responsibility where in the team
member who is assigned this role will have the responsibility to handle and achieve the particular
task. This is followed by Accountable, the Individual who will be answerable for the activity will need
to approve the work that member who is responsible does. Also for every task, there has to be just
one role and not multiple with this level of responsibility. The team members who are assigned the
consulted level are typically subject matter experts and others have to take their opinions to review
the work. And then those member who need to be informed and made aware of progress should be
notified to be notified as a form of one- way communication.
5. Team Development
Team building and development are the act and process of forming, growing and improving the
knowledge, skills and attitudes of individuals from different needs, organizational units and
professional background, into a cohesive, motivated, dedicated high performance team. (David
I.Cleland and Lewis R. Ireland, 2010, p.362 )The team of the project needs to include members with
different expertise and qualifications to ensure they are motivated and can handle their tasks
appropriately. There are five stages for developing a team out of which the first four were developed
by Bruce Wayne. And later on, Tuckman along with Mary Ann Jensen introduced the fifth stage.
The five Stages that will be used in developing a team for the PROSALO Project will be the folowing
Forming
This will be the first meeting for all teammates and they will be introduces to each other
where they will share information about their backgrounds and experiences and will get
acquainted with one another. The team will be formed and they will be introduced by the
project manager to the project objective and roles they will be expected to play. In this stage
the team will be completely dependent on the project manager to give direction and provide
structure to the group. Team members are quite inquisitive during this stage. Also, the initial
processes and procedures of the project will be defined for the various operations.
Storming
In this phase, the team members will be developing as a team. The team will now start to
apply their skills and will compete for acceptance of their ideas. The Project manager can
expect some conflicts during this stage as everyone will have different opinions. The need
will arise for agreements on handling conflicts. In this stage the project manager needs to be
less directive and provide clarification on roles and responsibilities of team members along
with providing support and guidance
Norming
The team members now have started working together more effectively and the
relationships between them have now become more settled and have accepted their
operating environment. The sharing of ideas and information increases. The project manager
6
is now more supportive and less involved however they will make sure that the team works
collaboratively and moves in the right direction
Performing
The team in this stage, has been consistently performing well and are focused on the goal as
a team. A lot of progress has been made and is recognized so the satisfaction levels are very
high. The attention of the project manager during this phase in on the progress and
accomplishments and acts like a mentor for the team.
Adjourning
At the end of the project, the teams members will be moving off to new projects or jobs. The
project manager should ensure that the success is celebrated and capture best work
practices for future.
6. Escalation
It is imperative for a project manager to monitor the project very closely in order to avoid any harm
or delays to the project. Although the team will try and resolve issues internally there may be some
serious issues that need the involvement of the upper management are vital to this stage. The
manager needs to identify and evaluate the issue and realize what damage it can do and depending
on the issue and can escalate it to the authorities for a timely resolution. The management needs to
be made aware of the problem and such issues need higher priority. The approache to identify the
criticality of the issue will be defined so that the roles can be distributed in advance to avoid any
major issue that could impact the project.
7. Stakeholder Management
It is vital to recognize the stakeholders who are in anyway involved or impacting the project. It is
imperative to develop relationships with any person or an organization which can be your
stakeholder at a very early stage of the project so that various techniques can be followed to analyze
their influence and also then develop various strategies to manage and communicate with them
effectively. Also It is important to communicate with the stakeholders on the regular level depending
and develop constant links of communicating till the closing of the project. In this project, during the
planning stage a stakeholder analysis was conducted in which we recognized our major stakeholders.
Various steps were taken in this process like identification of various person or organizations and
their role, needs and level of authority and how they could impact the project.
In the planning stage, it was recognized with the help of past studies in similar projects that the
Brussels Ministry of Environment as one of our major stakeholders as they have a very high power
and an extremely high level Interest in the project as they approve our legal procedures to set up the
office . We have very carefully examined there rules and regulations of the entire process and will be
taking all the necessary actions to avoid any delays or concerns regarding getting the licensing and
the permits. During the course of identification we realized that Media will play an important role in
marketing and portraying the correct image of the new sales office in Brussels. Also they will be high
in interest as this will be generating a lot of Job opportunities and will open a whole new market in
Europe. Keeping in mind all the internal and external stakeholders it is understood that the Banks,
Communities , Staff, Board of company are also a part of it, they will all be kept informed and of the
project and will be under the constant communication.
7
8. Reflection
The importance of learning project management cannot be emphasized enough. During the reading
and learning phase it is realized that project management is a complex field which requires a lot skill
set in every role. As the project manager plays the most important role being the head and the
mediator between the sponsor and his team, how vital it is for him to have clear and effective
communication skills. Also the balance of all the competencies is a key ingredient to successfully
manage the project. They take a mission to deliver consistently and on time with the given budget
and meet the expectations of the stakeholder and sponsors. And most importantly, the project
managers rely on others for their success so they need to work in accordance with the whole team.
The importance of clearly defining the responsibilities so the objective is more clear to every member
is a challenging but an important task.
References
 Clements, James P., and Jack Gido. Effective Project Management. Mason, OH:
South-Western Cengage Learning, 2012.
 Cleland, David I., and Lewis R. Ireland. Project Manager's Portable Handbook. New York:
McGraw-Hill, 2010.
 Ottmann, Roland. The Naked Project Manager: A Book Based on Real-life Stories.
Röthenbach, Nuremberg: Ottmann Et Partner, 2012.
 PMI | Project Management Institute." PMI | Project Management Institute. N.p., n.d. Web.
11 Dec. 2016
8
Table of Contents
2. Project Controller
2.1 Introduction
2.2 Roles and Responsibilities
2.3 Project Planning
2.4 Project Cost Management
2.5 Reflection
9
2. Project Controller
2.1. Introduction
Nowadays the work in project management is getting more complex, it seems like too demanding for
the project manager to hold tons of things on their should at the same time. Project controller is
therefore born for separating the duties from project manager in order to enhance the efficiency. This
report is going to introduce how do I perform my role as a project controller in the project Prosalo
and how does this position contribute to the project. The concepts and process of the works will be
discussed deeply.
2.2. Roles and Responsibilities of Project Controller
First of all it is important to know about the role of project controller in a project. Although the job
duties of project controller is recently widely expanded and subdivided into many different category,
they can be still briefly introduced as using scientific methodology and tools and also analytical skills
to: 1) develop and maintain schedule, 2) estimate costs and draw up budget baseline, and 3) monitor
the progress on project and forecast the impact of change (ACostE, 2007, p.11).
2.3. Project Planning
Project Life Cycle and Milestones
A project is a temporary endeavor which has a defined life span with a actual beginning and an end
and contain a specific target to achieve (Melton & Trish, 2007, p.7). The period between the start and
the end of a project is referred as project life cycle. Typically a project life cycle passes through four
distinct stages: defining, planning, executing, and finally delivering (Lasson & Eric & Gary & Clifford,
2011, p.7). However, depending on the scale and scope of project, the life cycle can be expanded
base on these 4 phases. The life cycle of Prosalo, apart from those 4 typical stages, “testing” is added
in between executing stage and delivering stage in order to confirm the office is usable and all the
employees are well-prepared for work as the team hope that the office can run smooth once it start
operating. Therefore, Prosalo is a project which is based on a 5-phase-life-cycle.
As mentioned before, one of the key role of project controller is planning and scheduling. The project
life cycle makes a outline of Prosalo from beginning to delivery, but objectives of those stages are still
missing. The final product of a project work is a bundle of success from each project phases, thus it is
important to clarified the specific targets needed to achieve in every single stage. It is hard to have a
plan or know what to do without expected output, those expected output of different stages are
known as “Milestones”. Milestones are those events which are meaningful and significant for the
project and need to be finished before going to the next step. They should be a solid event, or and
10
object, because the milestones should tell the result of a phase but not a work which is pending to
do. Normally there are at least 4 milestones in a project as the team have to achieve certain target
otherwise the next stage can not be started. For instance, it is impossible to hire employees directly
without any strategies and planning or delivery the office before finishing interior design.
Besides indicating handover from one phase to the next phase, the importance of milestones is to
provide “Control Gate” to the project. There is possibility that some of the deliverable are missed or
the performance can not fulfill certain of standard. Milestones give a chance to the project team to
have a review for the last stage to see if the project is suitable to continue to the next stage. If
problems were found, the team have to determine how to tackle those problems. It could be
accepting the problems, making improvement, changing objectives, or even stop the project if things
go wrong seriously. The existence of milestones makes each phase of project as individual mini
project and it is obviously easier for planning and controlling (Mike, Laurie, 2007, p.64). The quality of
project can be ensured as deliverable and result would be reviewed at every milestone and
appropriate action can be taken.
After understanding the characteristic and functions of milestone, the project controller of Prosalo
could start to think about which milestones should be included in the project. The objective of
defining stage is basically same among all the projects. In this stage, the project management should
understand ideas, concepts and requirement of the project and confirm the scope which will make
benefits to the customer. Planning stage then comes after the defining stage. The target of Prosalo
can be mainly divided into two parts - setting up a office in Brussels and hiring 12 young talented
employees. As they are two totally different types of product, it is necessary to manage them
separately. On the office side, the decisions of office planning should all been made including
location, office needs and people who should be contacted such as government authority and
contractors. On the other hand, decisions about hiring and training strategies should also been
made at the end of the planning stage, which may include requirement of candidates, the flow of
interview and training’s arrangement. The project management then go through the planning stage
to the execution stage. Most of the products of Prosalo are expected to finish after this stage. There
will be totally 4 milestones here. Firstly, the office’s location should be settled, which means, all the
contract and licensing work are accomplished. This is only a vacant office so the next objective is to
have a usable office by interior design and furnishing. Furthermore, after some process of
interviewing and hiring, 12 young and talented employees are hired. Training and exam will then be
provided to ensure their ability in the future career so the employees are all well-prepared at the
end of the execution stage. The final milestone, also as the final product of Prosalo, the office will be
delivered to WING at the closure stage.
11

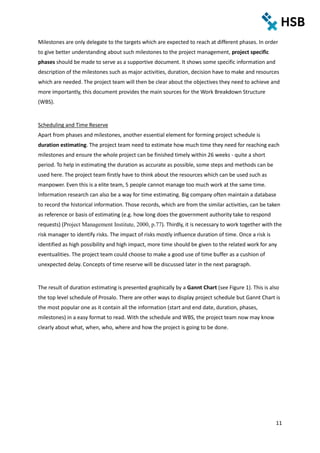

Milestones are only delegate to the targets which are expected to reach at different phases. In order
to give better understanding about such milestones to the project management, project specific
phases should be made to serve as a supportive document. It shows some specific information and
description of the milestones such as major activities, duration, decision have to make and resources
which are needed. The project team will then be clear about the objectives they need to achieve and
more importantly, this document provides the main sources for the Work Breakdown Structure
(WBS).
Scheduling and Time Reserve
Apart from phases and milestones, another essential element for forming project schedule is
duration estimating. The project team need to estimate how much time they need for reaching each
milestones and ensure the whole project can be finished timely within 26 weeks - quite a short
period. To help in estimating the duration as accurate as possible, some steps and methods can be
used here. The project team firstly have to think about the resources which can be used such as
manpower. Even this is a elite team, 5 people cannot manage too much work at the same time.
Information research can also be a way for time estimating. Big company often maintain a database
to record the historical information. Those records, which are from the similar activities, can be taken
as reference or basis of estimating (e.g. how long does the government authority take to respond
requests) (Project Management Institute, 2000, p.77). Thirdly, it is necessary to work together with the
risk manager to identify risks. The impact of risks mostly influence duration of time. Once a risk is
identified as high possibility and high impact, more time should be given to the related work for any
eventualities. The project team could choose to make a good use of time buffer as a cushion of
unexpected delay. Concepts of time reserve will be discussed later in the next paragraph.
The result of duration estimating is presented graphically by a Gannt Chart (see Figure 1). This is also
the top level schedule of Prosalo. There are other ways to display project schedule but Gannt Chart is
the most popular one as it contain all the information (start and end date, duration, phases,
milestones) in a easy format to read. With the schedule and WBS, the project team now may know
clearly about what, when, who, where and how the project is going to be done.
12
(Fig 1. Top Level Schedule of Prosalo)
No matter how much effort have been put on the duration estimating, the project schedule is still
only an assumption. There are many factors which may cause potential delay to the project and the
project team can never guarantee timely completion of the project. Therefore, time buffer (or time
reserve) should be applied to raise the probability of finishing project on time. Mainly there are two
ways to find buffers - they can be feed into the project schedule intentionally by starting all activities
as early as possible, which is called Critical Chain Management; another one is to discover buffers by
network path computation, which is known as Critical Path Method and the following paragraph will
be focusing on this method.
As mentioned before, the final product of a project is normally a result of two or more small
achievement. These achievement have different start and end point and go forward by their own
path. It is almost impossible all the milestones are reached at the same time so the duration of each
path can be very different. Even some of the milestones can be reached relatively earlier, they still
need to wait for the the result of the long path, otherwise the project can’t go to the next step. There
are two main path of Prosalo, one is office setting and another is employees hiring. Office setting
needs longer duration because of waiting for respond of government authority, licensing and interior
design, while employees hiring takes shorter time as interviewing is not a complicated process.
However, although all the employees can be hired in a short time, exam can only be given them once
the office is well-prepared and usable. The period that one path need to wait until another path to
finish is known as slack. The path with the longest duration is called critical path as there are no slack
you can find in this path (Fahad, 2014). Let’s say duration of the critical path in Prosalo (office setting)
would last for 13 weeks, and duration of hiring new employees is just 6 weeks. If they both start at
the same point, the path of hiring employees would have 7-weeks-slack before going to testing stage.
Project team can therefore spare more resources to the critical path as it is tighter.
13
With the Critical Path Method, project controller can then calculate the total and free slack’s number
of different activities. Total slack means the amount of time that a activity can be delayed without
delay the project completion date. Free slack means a activity can be delayed without delay the early
start date. (Dennis, 2007, p.217) The forward pass approach generate the early start and early finish
date (ES / EF) of all activities and the late start and late finish date (LS / LF) of activities can be
calculated by backward pass approach. After doing some simple calculation with the ES / EF and LS /
LF then we can get the amount of total slack and free slack.
Actually the Critical Path Method is not a perfect way to deal with potential delay. The emphasis of
this tool is to find out the slack from non-critical path and allocate resources to the critical path.
However, this is optimistically expect all the resources are available all the time. On the other hand,
the activities lying on the critical path have no buffer at all, even they got more resources from the
project team, it is still a challenge to finish those works within the duration. But still the Critical Path
Method is an ideal tool for Prosalo as it draws special attention to the critical path and it is good for
contingency planning and controlling the project which is not so complicated like Prosalo (Fahad,
2014). Last but not least, the resources needed to use in this project are not so much, resource
dependencies is therefore not a problem.
2.4. Project Cost Management
Project Cost Estimating and Baseline - Challenges and Limitation
The importance of cost to a project do not have to mention specifically. Project controller not only
need to calculate the cost of needed resources, but also decide how much cost should be spent on a
activity depending on it’s estimated effect. Cost of project mainly come from resources. The first step
of cost estimating is to determine what kind of resources are needed (e.g. people, equipment,
materials), quantities of those resources will be used and which activities would need them.
Milestones, WBS and historical information are the main input to determine needed resources
(Project Management Institute, 2000, p.85). Project controller should discuss with quality manager
about the scope of project as different objectives may need particular resources to fulfill in order to
maintain the quality of the project.
Once defined all the resources the project need, cost estimating can be started. This is a challenging
work because of different limitation. Ideally project controller need to estimate the cost of all
resources, and then allocate them to different work packages to get a project cost baseline. Project
Manager will hand in the budget plan to the management in order to request for budget. However, in
14
reality, the sequence is always reversed. The management will firstly provide the project team a
certain amount of budget and the team have to decide how to allocate the budget, and Prosalo is one
of the case. On the other hand, project team need to think about the balance between those 3
factors in the project triangle. When project controller try to reduce project cost, there will always be
conflict against time and scope. For example, hiring one IT technician is definitely cheaper than hiring
two, but the time for setting up computer and network will probably increase. Cost can also be
reduced by canceling the exam, but then the quality will be a doubt. Project controller should have a
good communication with quality manager because time and performance are always prior to cost
(within budget is okay) in their perspective. Nevertheless, cost estimating and budgeting are still
needed so project manager can gain more budget from the management in case it is necessary.
The approach that Prosalo used is call Analogous estimating(see Figure 2). This technique is also
called top-down estimating. Basis of top-down estimating come from previous project which is
similar to Prosalo. Estimator refer to the numbers of previous project to determine the project total
cost (Dennis, 2007, p.55). Generally speaking, this technique is base on experience and information.
Top-down estimating is especially good for the initial stage of the project as no one has detailed idea
about which resources are going to be used (Larson, 2011, p.132). But the low accuracy is a huge
drawback - basically top-down estimate is a kind of “guesstimate”. Firstly, it is unusual that a previous
project exactly same as the current project. Maybe there are some cases which are also
about setting up a office, but Prosalo is quite special, which is a project aiming to set up a sales office
in Brussels (the rent in Brussels is high) with a showcase room. Thus it is hard to estimate the cost of
Prosalo by referencing other projects. Secondly, project team may not be familiar with all the aspects
of the project. There are none of the team member has the expertise and experience in dealing
construction work and interior design. The estimated cost of this activity is totally base on
information from internet. No one knows if it is correct, or to what extent it is accurate. Because of
the low accuracy, it is a challenge for the project manager to gain more budget as the details can not
be provided to the management.
15
(Fig 2. Top-down cost estimating using WBS)
Concepts of Bottom-Up Estimating
There is another approach which is more efficient and accurate call bottom-up estimating. This
approach involves in the work package level and estimate the cost of individual activities. These
individual cost will then be rolled up to bring about a project total cost (Dennis, 2007, p.55). The
bottom-up estimating method is more reliable because it is on the basis of the WBS. Cost are more in
detail and false can be minimized. Three things have to be aware in order to raise the accuracy of the
result. First of all, project team have to define resource requirement as detail as possible. Secondly, all
the team members should join the estimating. The team member who are responsible for one
specific activity have to do the cost estimating for such activity because he/she is familiar with it. Of
course it will be even better if the team member have relative knowledge or experience of that
activity (Larson, 2011, p.132). Thirdly, bottom-up estimating raise not only accuracy but also cost,
project team have to make a balance between additional accuracy and additional cost (Project
Management Institute, 2000, p.88).
Budget Reserve
In order to tackle with identified and unforeseen risks, project controller also need to make cost
reserve by cooperating with the risk manager. Risk manager will first find out and define the potential
risk. According to the probability and harmfulness of the risks, fund will be allocated to different work
16
packages, this is budget reserve. There is a per cent amount of total budget putting on the top level
of the whole project to cover unforeseen risks and it call management reserve.
2.5. Reflection
Though the process is full of challenges, I am still very happy and enjoy a lot of of being the project
controller of Prosalo. This project gives me a new understanding for planning. In the past the only
concept about time in my mind is “deadline”. Finishing the job before the deadline means
requirement fulfilled. But works will be getting larger and more complicated with my position going
higher, sometimes the project is like a bottomless pit. Tools and techniques like phases, milestones
and time estimating would be very helpful to organize and control time. They are important because
they tell you what you have to do next and how you can reach the goal. Thus they are actually useful
in many aspect on the daily life in addition to only project management. On the other hand, at the
beginning I was worry about my position as one of the ability that project controller may have is
strong sense on number, unfortunately this is what I am exactly weak in. Scheduling and cost
estimating include a lot numbers and they make me stick there for a period a time. But in fact the
difficulty come from the concepts behind those numbers, the calculation is just simple mathematics.
People can always benefit from doing something they are not so familiar with because of attempting
and delving into the new thing. I am glad that finally I am not only able to finish the scheduling and
cost estimating, but also giving my analysis of those method to show that I really learn something
therefrom.
Honestly speaking there are many defects of this project. Mistakes can be made as this is our first
project management, but still it is necessary to know what can be improve in order to strive for better
next time.
1. The time schedule seems too optimistic. We will start to hire employees while at the same
time we start the task of office setting. Ideally, communication with the government and
signing contract would not spend much of time so we are able to manage other things. But
no one knows if this assumption is correct or not. It is better to ask for opinion from someone
who are experiencing or do more information research.
2. The Critical Path Method is not so secure. Although the critical path have the first priority for
using resources, it has no slack to against risks and uncertainty. And the assumption of
unlimited resources is too optimistic. Therefore, using the Critical Chain Management would
be a better option. This approach is more realistic and encourage us to work efficiently.
3. The top-down cost estimating is too rough. Lack of knowledge and information is a reason,
but the team can do more on thinking about the needed resources and duration. Even the
top-down approach is about guess, the more preparation you do, the higher accuracy you
get.
17
Bibliography
Books
Dennis Lock, 2007. Project Management. Gower Publishing, 9th Revised Edition.
Larson, W. Eric, Gray, Clifford F., 2011. Project Management. The Managerial Process. McGraw-Hill,
5th International Edition.
Melton, Trish, 2007. Project Management Toolkit: The Basics for Project Success. Butterworth
Heinemann, 2nd Revised edition
Mike Field, Laurie S. Keller, 2007. Project Management. Thomson Learning.
Project Management Institute, 2000. A Guide to the Project Management Body of Knowledge
(PMBOK® Guide), Project Management Institute, Inc., Pennsylvania, 5th Edition
Article
ACostE, 2007. Reining in your project controls - introducing the Project Controller. Project Control
Professional, May 2007, p.10-13.
Internet Source
Fahad Usmani, 2014. Critical Path Method (CPM) in Project Management. Retrieved from
https://pmstudycircle.com/2014/01/critical-path-method-cpm-in-project-management/
18
Table of Contents
1. Introduction
2. Quality Management Approach
3. Project Manager’s responsibilities
4. Project Priorities
5. Quality Assurance Plan
6. Review Plan
7. Reflection
8. Appendix
19
Quality Management
Introduction:
This quality management plan helps to define the level of quality to be maintained during processes
of the project and is backed up by requirements. It also describes the procedures by which the
project team will maintain the required level of quality in its work process, work packages, cost
budgeting, and deliverables. The goal is to maintain the Quality of work and produce results that go
beyond requirements. Following are the specific requirements of this project.
 Setting up Sales office in Prosalo
 Hiring 12 young professional employees
 € 150,0000 for total cost
 Time period for the project is 26 weeks
It is important to define what actually mean by quality in this project operationally. Quality in this
project is defined as “Setting up an sales office in a great location with infra-structure that is best
suited to young professional employees and their work environment within time frame.” The aim is
to hire twelve highly professional and competent employees, providing high quality training to them
and also providing certificates.
This Quality Management Plan for the PROSALO project will help to establish the activities in
processes, setting up procedures for maintaining the quality of projected work and services rendered
to the WING upon the completion of the project.
Quality Management Approach:
This portion portrays the approach that will be adopted to manage quality in entire project. Quality
management is essential to prevent un-necessary wastage of time and cost while providing desired
deliverables in the project. This quality management plan follows approach from “Process Quality” in
which quality is checked and maintained in time to time basis. This quality management plan is based
on following considerations.
 Priorities
 Quality Assurance/ Required Actions
 Review Plan
 Reflection
In order to ensure best quality, this Quality management plan describes various procedures following
which the project will be successful, the procedures are:
 Scheduling meetings
 Managing resources ( out sourcing , hiring procedure, testing instruments )
 Cost review
 Time analysis
 Checking with buffers in time/budget
 Feedback/ suggestions from employees
20
Project Manager’s Responsibilities
 Project Manager: Planning and Defining Scope. Activity Planning and Sequencing
 Project Controller: Working with project manager, clarifying objective and goal of the project
, creating project budget and schedule.
 Quality Manager: Working with project that fits with the office’s internal and external
requirements, also with legal compliance and office expectation. The main focus of quality
manager is to ensure that products meet certain quality standards. They plan, direct or
coordinate quality assurance programs and formulate policies for quality control. Their goal
is to improve the organization's efficiency and profitability by reducing wastage of time and
cost and maintaining high level of performance.
 Risk Manager: working with project loss control, finance, claims specialists, legal issues and
accounting
 System Architect: working with project behavior and structure
Priorities:
This project has diverse priorities according to the set milestones. At initial/planning phase, this
project focuses more on performance. At second stage/Operations mode, project members will focus
more on time. At the last stage/ testing phase, team members will focus more on cost. Over all, all
three priorities will be considered throughout the project according to the need of the situation and
project dynamics.
Quality Assurance Plan:
Having already defined the term "Quality" for this project, the Quality Assurance Plan includes,
sticking to the quality control process by taking required actions at the required times that are as
follows:
 Continuously conducting meetings with other leading members of the project.
 Reducing communication gap and providing free access to important information and details
about the project and also facilitating communication between the leading members of the
project.
 Preparing audit report of budget so that this project will not exceed the required limit.
 Checking real-time milestones in order to ensure that project is going on within the time
frame and the deadlines are being met.
 Trying to figure out and alleviating reasons, if any member of the project is not satisfied with
project operations or any other factor.
 Making necessary audit report for deliverables (Office, Professional employees, instruments )
against cost.
 Testing Office infrastructure and employees capabilities ( after training )
 Every manager will make report on his/her duties that reflects performance
 Getting Feedback from fresh employees about office location, infrastructure, hiring process,
and communication to their boss.
21
Expected date to carry out activities
Date Activities Results
24th
Nov 2016 Conduct meeting in order to reduce communication gap and
introduce team mates and briefing of project’s requirements,
quality standard and basic time frame.
Positive
28th
Nov 2016 Discuss in detail about Planning phase of project Positive
26th
Dec 2016 Finalizing Office Planning Pending
16th
Jan 2017 Finalizing Hiring Strategies and discussion in detail for operation
phase
Pending
6th
Feb 2017 Reporting for office execution Pending
20th
Feb 2017 Checking office Location with cost budgeting Pending
27th
Mar 2017 Checking office infrastructure and compare to actual cost Pending
10th
April 2017 Reporting for hiring process Pending
24th
April 2017 Checking if hiring process is already done and discussion about
testing employees and office infrastructure
Pending
1st
May 2017 Report of on-going testing procedure Pending
8th
May 2017 Detailed report about testing phase from responsible persons
and check with budget. If things are good, then discussion for
handing over this office to WING
Pending
12th
May 2017 Be sure that all preparation is already made Pending
15th
May 2017 Feedback from WING Pending
Through these activities, the project will have desired deliverables in a condition where other factors
such as time, cost and performance remain according to plan. On the contrary, if there is some
problem then it is then responsibility of quality management team; specifically of the quality
manager, that he makes alert log to identify the problem and take necessary steps in order to resolve
the issue. This could be done through the below sample chart:
Logs
Date Type of Problem Responsible
Authority
Suggested ( Action/Solution )
Deliverables
Time
Cost
Communication gap
Review Plan:
This section provides information about how this project is to be reviewed in order to reduce any
mistakes/error. This could be done by the “Quality Manager “for his record. And if quality manager
finds some problems in review plan then he should conduct meeting with other leading managers or
with specific manager, depending on the issue and the person responsible. This must be documented
in written form so that errors are corrected and responsible authority is approached to resolve this
issue. This project manages review plan in a format that is shown below.
22
Log
Date Review of activities Problems Responsible Appointment
Reflection:
At the very first stage, when all team members were assigned to complete this project in an effective
manner, all of them were not much familiar with terms “Work packages, Work breakdown structure,
milestone, stake holder register”. But after having brief instructions about these terms, all team
members are now well trained to cope with all kind of problems that may occur. In addition to this,
the instructions polished team member’s internal potential for analyzing situations in a critical and
serious manner. The Project manager was facing a problem in dealing with the sponsor but finally
project manager succeeded in convincing the sponsor, reduced communication gap among all other
leading team members. The System architect faced problems with short span of time but with the
help of samples of other similar past projects, this project system architect managed everything in a
very smooth manner. In general, all risk managers always find complications about legal
documentation, but in this project, risk manager did an excellent job in drawing appropriate legal
documents. Since this project has little budget, project controller encountered few difficulties while
analyzing top to down budgeting approach and bottom to up budgeting approach but the project
controller did tremendous efforts in order to meet requirements while keeping quality of
deliverables. Quality manager was little bit confused in defining the term “Quality “in this project.
But due to excessive amount of collaboration with other top level management, Quality manager
was able to define “Quality “in this project in a right manner considering the requirements of
projects.
23
Appendix
QUALITY
There is a wide variety of definitions of quality. Walter Stewart defined quality as the goodness of
product. Later this definition was broadened and extended to both products and services. A query
was conducted on numerous managers in the United States to state their definition of quality. The
following nine definitions were the most popular:
1) Perfection
2) Consistency
3) Eliminating waste
4) Speed of delivery
5) Compliance with policies and procedures
6) Providing a good, usable product
7) Doing it right the first time
8) Delighting or pleasing customers
9) Total customer service and satisfaction
(Evans 2008, pp.6)
Quality management system (QMS) is a formal system that includes documenting the structure,
responsibilities and processes required to achieve effective quality management. In addition, quality
management is defined by American Society for Quality as follows: “The application of a quality
management system in managing a process to achieve maximum customer satisfaction at the lowest
overall cost to the organization while continuing to improve the process” (ASQ, 2013a).
Reflection model:
This model highlights that experiences in learning combine behavior, ideas and feelings and all of
these aspects need to be examined in the process of reflection. (Boud, Keogh and Walker,1985).
24
Table of Contents
4. Systems Architect
4.1 Use cases
4.2 Requirements Definition
4.3 Plan for Verification, Validation
4.4 Reflection
References
25
4.1 Use Cases
Project Baseline Report
As a “Systems Architect” of the project “PROSALO” who is responsible for looking for the tangible
output in the view of user perspective, I determined to deliver the project not only to meet the
needs but also satisfy all people operating the sales office after the end of the project. I do consider
and concern the requirements from WING and also our young professional employees by using users’
stories as a tool to do the project more understandingly and effectively. The aim of my work is to
closely coordinate with management team and put the role of “Systems Architect” during the project
to monitor each process to achieve as planned.
There are two major deliverables that require careful monitoring and verified testing before handing
over to WING: a Sales office and 12 young professionals.
26
“Sales office”
According to “Top Level Schedule”, the decision regarding to office planning will be done first in LM2
(within 4 weeks). What should be done in this process is the project management team needs to
clearly understand requirements and reach an agreement. Thus, everyone has a chance to propose
ideas and clarify things to make sure we are on the same track during the planning. As a role of
systems architect, location (2.1.1) and office needs (2.1.3) are my major tasks from Work Breakdown
Structure (WBS).
In planning process, the project management team and I as systems architect have come up with
obvious requirements of the sales office as follows
- Located in downtown area but not too showy
- Enough space for showroom and 12 employees
- Renting is in a budget
- Able to make a contract within desired period of time
For office needs, keeping in mind on users’ most benefits, it’s advantageous to list all utilities in each
room which relates to the features and functions in order to easily hand on the list to a contractor to
purchase all products with the requirements.
Utilitty List
Utilities Requirement Approx Cost Number Note
Room: Kitchen
1.Table Spacious & Durable EURO 100 1 For 12 Pax
2.Chair Comfortable, Durable & Light EURO 10 Each 12 -
3.Coffee machine Italian brand EURO 200 1 -
27
In the step of execution for the office, I need to cooperate more with a quality manager during
construction and design (3.1.3) to ensure standard and security of infrastructure. To do so, the
strategy of our project is to do make a weekly report to check the advancement of the project and do
“Initial testing” for things right away after installation to check such functions. However, the all
verification of the office will be absolutely checked again during office testing (4.1) with the plan of
verification and validation.
Report Week 10
Construction
And Design
Installment Completion Initial Testing Quality Manager
1.Electricity Done 100% Verified ((Signature))
2. Interior design On process 68% - -
3. Office utility
3.1. Table and Chair On process 10% - -
“12 young professionals”
According to “Top Level Schedule”, the decision regarding to hiring strategies will be finalized in LM3
(within 3 weeks). As a role of systems architect, requirements of employees (2.2.2) are my
responsibility from Work Breakdown Structure (WBS). So, in order to support and assess young high
potentials to participate in the project, it is necessary to set up appropriate job requirements to
attract those who are ready and well qualified to join.
- Male or female based in Brussels
- Aged 22-25 years old
- Bachelor’s degree or higher in Public Relations, marketing or any
related fields
- Fresh graduate is welcome
- Good command of English in writing and speaking
- Creative and critical skills
- Green energy knowledge is a plus
- 1-year contract
With the assistance by quality control who examines the job requirements, I can conduct a good
work. Fortunately, I also appreciate the help from risk manager who proposes on signing-a-contract
condition to reduce employee turnover which will waste time and cost during the project if such
cases occur.
By the time of LM6 which employees will be hired, I have got 13 weeks since LM3 (Decision regarding
to Hiring Strategies). After job postings, I would take responsiblity on recruting candidate and setting
up interview (3.2.2) to secure WING to have right people working with. Ones who can pass through
the interview process are those who show high enthusiasm on this job which means who are readiest
and well qualified according to job requirements.
28
Candidates who get through the interview sesion have to do written examination before the real
interview with committee which comprises of a person from WING, one from MASA, Project
Manager and me as a Systems Architect.
Written examination would be psychometric and aptitude test related to each role of jobs (sales,
accountants, secretaries) to assess the personality and characteristics of candidates match each job
role. To illustrate, for sales officers we require those who obtain self motivated, strategic thinking,
personal diplomacy and influencing on customers‘ decision.
Eventually, to evaluate and find 12 young professional employees who fit PROSALO, those candidates
have to impress all committee during the interview which we also agree on these extra requirements
who can be obviously seen from such final criteria: hardworking, team player and creativity.
4.2 Requirements Definition
A requirement is a formalized statement identifying a capability, a functionality, a physical
characteristic, or a quality that must be met or possessed by a system or system component to
satisfy a contract, a standard, a specification, or other formally imposed documents
(ISO 10795, 2013)
PROSALO is a challenging project which I prioritize the requirements in order to satisfy WING who
anticipates the success of the project and facilitate employees who will operate the sale office in the
future. To meet those needs from both sides, as a systems architect, I choose to have procedure to
run on my work.
Steps of requirements management
1. Identify requirements
In every stage of work, we always start with the requirements of stakeholders who are WING and
employees to know what their needs are. Also, it helps me to avoid last-minute requirements that
may happen unexpectedly which will bring about risks to the project.
2. Manage the demand considering time, cost, scope + customer satisfaction
After working based on requirements from stakeholders, the project should be executed under the
triple constraint. For example, the office meets all requirements in terms of nice location, well-
equipped office but it delays to hand over for a month or costs double of the budget. It is a failure.
Thus, it is unavoidable to take strong consideration on time, cost, scope and especially customer
satisfaction.
3. Review
Eventually, each task of work needs to be reviewed whether it functions correctly or needs to be
fixed. Otherwise, how does the defect or malfunction meet the requirements? As a result, an
effective plan for verification and validation should be initiated.
29
4.3 Plan for Verification, Validation
Verification is to ratify that the system meets the requirements while validation is to ratify that the
systems meet stakeholders’ needs and expectations. After we have done these steps, next is
acceptance testing which allows us to coordinate with customers whether they accept the system
and feel pleased to pay.
Our plan is to have initial testing in execution (3) and completely huge verification and validation in
testing (4). After each task in execution process has been done such as construction and design, in
order to reduce uncertainty of an occurrence which will have an impact on the project, it is crucial to
verify the system right away after the installation for example, electricity in the office, computers,
and other office utilities.
Then, the plan for verification, I as a systems architect I decided to adopt Verification Process: V-
Model to run through the whole office testing (4.1) and examination (4.2) of new employees (after
being trained) in testing (4). There four stages of verification process: inspection, review, analysis and
test to double check the office, infrastructure, utility and new employees whether they meet
requirements or not. Those which/who perform under the standard must be improved and verified
again.
(Prof. Dr. H. Meyer / Dipl.-Ing. Heinz-Josef Reher, 2012)
Last but not least, if there’s still a problem, we need to work on that immediately with project
management crew related to issues to find the best solutions for problems caused. And, when
everything goes well, we could pass through to validation of the project to be ready to hand over on
LM8 (one week before the duration of PROSALO).
30
4.4 Reflection
“Systems architect” is a person who dedicates a lot in this project. In my opinion, it is the person who
focuses on how it is going to be used, how useful the stuff is, and how impressive the people who use
it will feel. Apparently, what really helps me is “having the idea of user’s perspective” because if you
know what their requirements or what they want, it gives you a clearer idea of what it is and how it
looks like. What could be the problems during the project is “having too much the idea of user’s
perspective”. The reason why I assume like that is when you care too much on customers’
requirements, it gives you hard work too. Sometimes, what they need cannot meet with the triple
constraint such as real cost, limited time and scope (eg. scope creep). So, it should be well balanced.
Finally, without coordinating much and keeping close contact with quality manager, project manager
and the risk manager, I as being a systems architect wouldn’t perform the work successfully.
31
References
Dick Billows. Project Requirements. http://www.4pm.com/project-requirements-management, 2016.
Accessed at November 30, 2016.
Gerrit Muller. The Role and Task of the System Architect.
http://www.gaudisite.nl/RoleSystemArchitectPaper.pdf, 2011. Accessed at December 3, 2016.
Institute of Phychometric Coaching (IPC). http://www.psychometricinstitute.com.au/Managers-
Sales-Business-Development.html, Accessed at December 2, 2016.
ISO 10795. Requiremets Management. https://www.iso.org/obp/ui/#iso:std:iso:16404:ed-1:v1:en,
2013. Accessed at November 29. 2016.
32
Table of Contents
Introduction
5. Risk manager
Case study: Prosalo
Role of risk manager
5. 1 Risk description
5.1.1 Risk management planning
5.1.2 Probability and impact
5. 2 Risk evaluation and portfolio
5.3 Risk strategy and mitigation plan
5.4 Reflection
References
Appendix
33

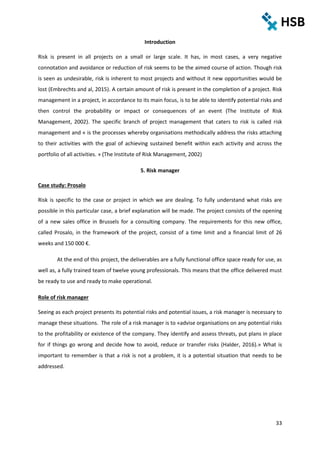

Introduction
Risk is present in all projects on a small or large scale. It has, in most cases, a very negative
connotation and avoidance or reduction of risk seems to be the aimed course of action. Though risk
is seen as undesirable, risk is inherent to most projects and without it new opportunities would be
lost (Embrechts and al, 2015). A certain amount of risk is present in the completion of a project. Risk
management in a project, in accordance to its main focus, is to be able to identify potential risks and
then control the probability or impact or consequences of an event (The Institute of Risk
Management, 2002). The specific branch of project management that caters to risk is called risk
management and « is the processes whereby organisations methodically address the risks attaching
to their activities with the goal of achieving sustained benefit within each activity and across the
portfolio of all activities. » (The Institute of Risk Management, 2002)
5. Risk manager
Case study: Prosalo
Risk is specific to the case or project in which we are dealing. To fully understand what risks are
possible in this particular case, a brief explanation will be made. The project consists of the opening
of a new sales office in Brussels for a consulting company. The requirements for this new office,
called Prosalo, in the framework of the project, consist of a time limit and a financial limit of 26
weeks and 150 000 €.
At the end of this project, the deliverables are a fully functional office space ready for use, as
well as, a fully trained team of twelve young professionals. This means that the office delivered must
be ready to use and ready to make operational.
Role of risk manager
Seeing as each project presents its potential risks and potential issues, a risk manager is necessary to
manage these situations. The role of a risk manager is to «advise organisations on any potential risks
to the profitability or existence of the company. They identify and assess threats, put plans in place
for if things go wrong and decide how to avoid, reduce or transfer risks (Halder, 2016).» What is
important to remember is that a risk is not a problem, it is a potential situation that needs to be
addressed.
34
5. 1 Risk description
5.1.1 Risk management planning
In order to manage your projects risks, a plan must be laid out. Initially, identification of risks needs
to be done. In this stage, potential risks, causes and effects, tailored to the needs of your project,
need to be identified. Risk triggers, which can be compared to warning signs, are things that can help
you anticipate a possible risk to your project (Project management knowledge, 2016). After this, risk
analysis is necessary: evaluation of the probability of occurrence and impacts of risk, creating a short
list of most critical risks and evaluation of the feasibility and viability of the project fallowing the
results. Thirdly, a risk response plan and strategy is put in place (Project management, class slides,
2016).
5.1.2 Probability and impact
Importantly, at the beginning of the risk identification process, it is worthwhile, and crucial to set
common guidelines for the team in terms of probability and impact and how to evaluate them. In the
case of Prosalo, the scale for probability was set as follows: Low, medium, high, very high. Each of
these categories represents a percentage class, meaning the possibility that an event will occur out
of one hundred (Table 1).
Table 1: Evaluation of probability of risks in percentage
Probability Occurrence probabilities (%)
Low 1-25
Medium 26-50
High 51-74
Very high 75-100
As for the impact, it too will have a scale set as follows: Low, medium, high, very high. In this
case, three distinct categories can be affected. These categories refer to the triple constraints:
Performance, cost and schedule (time) (Table 2).
Table 2: Evaluation of impact of risk with performance, cost and schedule constraints
Performance Cost Schedule
Impact Achievement of requirements
Increase in
developmental costs
Delay
Low Errors only perceived < 5K € < 2 weeks
35
internally (Prosalo)
Medium
Slightly degraded
performance
≥ 5K € to < 40K € ≥ 2 weeks to < 6 weeks
High
Significant impact of
performance, inability to
deliver the project on time
≥ 40K € to < 65K € ≥6 weeks to < 8 weeks
Very High
Endangering the mission of
the project and feasibility of
delivering office
≥ 65K ≥ 8 weeks
Once the risk probabilities and impacts determined and evaluated, the risk level can be
determined. Once the risk level is clear, a certain prioritization can take place (Appendix 1). These
levels will also help plan responses to be taken in terms of the different risks (Project management,
class slides 2016).
5. 2 Risk evaluation and portfolio
In terms of the Prosalo project, many risks where identified. Three of the main risks where the
following delay in project approval and permits, technical issues with devices and employee turnover.
A risk register was created for our project (Appendix 2).
The first risk would be described as follows; if there is a delay in project approval and permits
then the office delivery to WING will be delayed. The initial approval of the project will have to be
given by government bodies. This step is very important because the continuation of the project is
not possible without initial approval. Possible risk triggers for this are missing documents, changes in
legal aspects, different legal aspects in different countries, translation necessities that may take time.
The main constraint affected in this is time. Seeing as these approvals are a major concept in the
Prosalo project the impact of this risk is high (inability to deliver the project on time and significant
impact on overall performance of the project) and the probability is medium seeing as the amount of
paperwork needed will be high and therefore necessitates more time to process. These impact and
probability levels give an overall medium risk level. It is evaluated that the cost of this risk may be
equivalent to a four week delay period. The risk owner to this problem is the project manager seeing
as he or she will be the one in contact with government organizations.
The second risk that of technical issues with devices; if there are technical issues on devices,
then the employees cannot work in a supportive environment. The installation of such devices will
take place during the execution phase of the project. This step will permit the office to be ready on
36
time and operational at the date of delivery. The trigger for this risk is the installation of devices in
the office throughout the execution phase. The major effect is on cost and time and they are
estimated to be of 2000 € and 2 weeks to fix any potential problems. The impact is therefore low
because it is a problem that is only perceived internally. The probability is high seeing as a completely
new technology and information system is being set up. These impact and probability levels give an
overall low risk level. The risk owner to this problem is the system architect.
The last risk identified it that of employee turnover during the process of the project which is
to say during the hiring, training and post training phase before delivery of the office; if there is
employee turnover, then it will be necessary to repeat the hiring process. The trigger to this problem
is negative feedback given by the employee to the management team or trainer throughout or after
the training process. The low number of employees hired (12 total) places this risk at a high impact
level. If one employee leaves, a big part of the work force is gone. The major effect is in terms of cost
and time and they are estimated to be of 1500 € and 4 weeks to fix any potential problems because
of the necessity to train a new person. The probability of this happening is low seeing as all
employees will be made aware of the implications of the job at the time of interviewing and hiring.
The overall risk level is therefore low. The risk owner to this problem is the quality manager.
5.3 Risk strategy and mitigation plan
Strategies have been put in place to respond to each of the risks identified. Strategies are present in
order to make informed decisions about the steps to be taken to manage risk. The strategy is there
to help reduce the impact and/or the probability of a certain risk (Project management, class slides,
2016).
In the case of the first risk identified, delay in project approval and permits, the response
strategy to be taken would be acceptation and reduction of risk. Seeing as a part of this process is in
the hands of an institution that is exterior to the project, part of this risk is harder to manage. This is
where accepting of the possible outcome will take place. However, steps will be taken at the
beginning of this process in order to reduce the risk of this occurring. Making sure all necessary
documents are present and in order, making sure all translations of documents are available and all
legal requirements are met are the steps that will be undertaken.
In the case of the second risk, technical issues with devices, the response strategy is reducing
the risk probability. Once the planning phase and the office setup is complete, set up of electronics
and technological services will begin as soon as possible before official opening. This will reduce the
37
chances of last minute problems. Also, the devices and software will be tested in phases after each
installation in order to avoid problems at the end and having to start the whole process over.
In the case of the last risk, employee turnover, the response strategy is reducing the risk
probability. The way to address this risk is to create contracts that will be signed by the employees at
the time of hiring giving a minimum employment time, for example one year. This way the desire to
leave during the course of the project will be reduced.

5.4 Reflection
The role of risk manager is very important in a project, it helps direct a project in the right way that
will help minimize potential risks. The goal of a risk manager is to identify risks and try to minimize
their impacts and probability. Though risk managers formulate risk registers and determine what
strategies to use in order to achieve their goal, they do not work alone and every member of the
project is vital to help him or her manage risk. Every risk falls under the responsibility of a member of
the project and it is a team effort. As mentioned earlier, every risk identified in this project has a
different risk owner that in every case is different than the risk manager. This shows that risk is in the
hands of every member of the team. The risk manager therefore works closely with all other roles.
It was identified that risk in projects can be internal or can have an external origins and the
level of control you have over every aspect is not necessarily complete. Identifying these risks is,
however, a key part of any project seeing as it permits you to overcome challenges, deliver projects
on time with as little disturbances as possible and have control over the course of action that your
project takes. The role of a risk management is therefore very important.
This project has been very enlightening for us as future management professionals. It has
permitted me to fully understand how and why it is important to plan and manage a project using
the right tools. Tools such as the work breakdown structure, the master schedule, the risk register,
the stakeholder register and the Gantt chart. Planning projects in this way permits you to have a
clear goal or path during the project as well as helping you control different factors that could,
without the proper tools, become confusing and poorly managed. In this way, you can have
knowledge of the outcome and path that your project needs to take and avoid the unknown which
can be a huge risk without project management. Project management is applicable in many areas,
such as report writing, projects, working on organizational skills and working in team environments.
This particular project context was very interesting because of the intercultural context of the class.
Being able to see one situation through different points of view and different backgrounds was
38
interesting and eye opening. It permitted us to try and understand one another and work on our own
strengths and weaknesses.
39
References
Embrechts, P., Frey, R. & McNeil, A. (2005) Quantitative risk management: Concepts, techniques and
tools. PDF. New Jersey: Princeton University press. (Viewed on December 10th
2016)
Halder, G. (2016) Job profile: Risk manager. Prospects.ac.uk. [Online] URL:
https://www.prospects.ac.uk/job-profiles/risk-manager (Page consulted on November 30th
2016)
Institute of risk management. (2002) A risk management standard. PDF. London. (Viewed on
December 5th
2016)
Investopedia. (2016) Risk Profile. Investopedia.com. [Online] URL:
http://www.investopedia.com/terms/r/risk-profile.asp (Page consulted on December 5th
)
Project management (2016) Slides MTM 2016: Risk management. Masters in international tourism
management.
Project management Knowledge. (2016) Triggers. Project-management-knowledge.com. [Online]
URL: http://project-management-knowledge.com/definitions/t/triggers/ (Page consulted
on November 30th
)
40
Appendix 1
Appendix 1: Risk level 1
41
Appendix 2
Risk register for Prosalo Project
Risk Risk Trigger
Major
Effects Impact Probability
Risk
level Strategy Action
Risk
Owner
If there is a
delay in
project
approval
and permits
then the
office
delivery to
WING will
be delayed
Missing
documents,
changes in
legal
aspects,
different
legal aspects
in different
countries,
translation
difficulties Time High Medium Medium
Accept
and
reduce
Give in well
prepared
documents
and make
sure all
necessary
documents
are present
Project
manager
If there are
technical
issues on
devices,
then the
employees
cannot work
in a
supportive
environment
Installation
of devices
Time
and
money Low High Low Reduce
Set up as
soon as
possible
before
official
opening,
Test the
devices in
phases after
each
installation
System
Architect
If there is
employee
turnover,
then we
need to
repeat the
hiring
process
Negative
feedback,
desire to
resign,
insatisfaction
of employee
Time
and
money High Low Low Reduce
Create
contracts
that will be
signed by
the
employees
at hiring
giving a
minimum
employment
time
Quality
manager

Project Management Report

  • 1.
    Project Management Module Professor:Helga Meyer “PROSALO Project Management” Submitted by Project manager: Kritika Gill Project Controller: Thomas Ying Quality Manager: Syed Hassan Systems Architect: Supanut Petrugs Risk Manager: Camille Beauchemin Master in International Tourism Management International Graduate Center Date: December 12th 2016
  • 2.
    1 Table of Contents 1.Project manager……………………………………………………………………3 1.1 Project Strategy…………………………………………………………….3 1.2 RASCI, Team Development and escalation…………………….5 1.3 Stakeholder Management…………………………………………….6 1.4 Reflection…………………………………………………………………..…7 2. Project Controller………………………………………………………………….8 2.1 Milestone, Phases, Concept of Time Reserves……………….9 2.2 Project Cost Baseline – Challenges and Limitations……..13 2.3 Concept of Bottom up Cost Estimation………………………..15 2.4 Reflection……………………………………………………………………16 3. Quality Manager………………………………………………………………….18 3.1 Priorities……………………………………………………………………..20 3.2 Quality Assurance Plan: Required Actions……………………20 3.3 Review Plan………………………………………………………………..21 3.4 Reflection……………………………………………………………………22 4. Systems Architect………………………………………………………………..24 4.1 Use cases…………………………………………………………………….25 4.2 Requirements Definition…………………………………………….28 4.3 Plan for Verification and Validation…………………………….29 4.4 Reflection …………………………………………………………………..30 5. Risk Manager………………………………………………………………………32 5.1 Risk Description………………………………………………………….34 5.2 Risk Evaluation and Portfolio………………………………………34 5.3 Risk Strategy and Mitigation Plan……………………………….36 5.4 Reflection……………………………………………………………………38
  • 3.
    2 Table of Contents 1.Introduction Background Objectives 2. Role and Responsibilities of a Project Manager 3. Skills of a Project Manager 4. RASCI 5. Team Development 6. Escalations 7. Stakeholder Management 8. Reflection References
  • 4.
    3 Project Prosalo 1. Introduction Background Themost important role in the project is that of a Project Manager and the roles and responsibilities he has to make a project successful. As he is responsible for overall management of the project, he is the sole person accountable to produce the end result. It is paramount to understand how the project manager interlinks and allocates the responsibilities to work towards one common goal. Research Objectives This paper is focused on the strategy used in the Project Prosalo, how the team was developed and various stages of team development. The usage of the RASCI method to assign responsibilities to have more clear objectives by each team member. Also, In depth understanding of the roles of the project manager and how he contributes to have a successful project. 2. Roles and Responsibilities of the Project Manager Project Managers are change agents: they make project goals their own and use their skills and expertise to inspire a sense of shared purpose within the project team (PMI). He is responsible for Initiation, planning, execution, monitoring, controlling and closure of the project. In the Initiation phase of Project Prosalo a detailed project charter was prepared. Apart from this the background of the Project which is the need to set up an office in Brussels along with benefits is mentioned which in case of Prosalo is staying closer to the changing trends of the European Market. The Charter has a clear and focused Mission statement and also the Exclusions, Budget of the Project to give a complete overview of the project. Planning It is imperative for the project manager to clearly define and clarify the scope of the project, project plan and policies and procedures to be followed during project. During the planning phase of prosalo, the vision was set in which clear objectives of the project were laid and the strategy of the project was thought of which will be implemented to achieve the goals. Also, a finished plan was prepared which describes what should have been achieved at the end of the project. Most favorable road map was selected which clearly describes the aims. In the planning phase the following was decided:  Scope of the Project: The Boundaries of the project were decided upon. The major objectives, tasks, goal, time and deliverables were established.  Work Breakdown Structure: The work structure will be planned in detail keeping each activity in mind and was designed into manageable sections. It is basically an outline of the entire project is designed keeping in mind major functional deliverables. This will eventually help the team to follow an organized work pattern. The team will make milestones and
  • 5.
    4 schedules that indicatethe change of phases and the events to control and analyze the progress of the project. This will also help the team to recognize the accomplishments.  Scheduling: In this segment, a critical path to finish the project was chosen and also the free slack will be decided upon.  Risk Assessment: Projects are always future oriented, which means they are subject to unforeseeable problems or risks. (Roland Ottmann, 2012, p.143) It is vital for a successful project to identify any possible risks that might affect the project. After careful evaluation with the team, customers and end users associated risks will be identified and the impacts it could have on the project and impact matrix was prepared and the strategy options will be decided upon to minimize or deal with the risk in the most effective way.  Stakeholder Management: All possible stakeholders will be identified and understood and according to their power and interest in the project and how they will managed to ensure no delays in the progress of the project.  Closing project Plan: This will be prepared to finalize all completed activities of the project to formally close the project. To ensure completion and identify the best practices and lessons for any future projects. Organizing, Monitoring and controlling The structure of the team will be set which will meet the needs at different stages of the project. Assigning responsibilities and authority to various team members various tasks. Also, leaders in the group will be designated power and responsibility who will be accountable for the tasks of their team and will report directly to the Project manager in case of any escalations. The progress will be tracked the progress of the project and monitor the progress of the assigned tasks and communicate same effectively to the team and management. Also, measuring team performance through reports ,documentation and assessing timelines and budget are needed to be controlled by the project manager. 3. Skills of the Project Manager Project Manager plays the most important role as he directs the entire operation. He has many responsibilities, from directing and maintaining the project plans to make reports of the performance of the project. He plays as a mentor to his entire team in terms of proving any sort of consultation in the team. He is the mediator between the sponsor and his team. He along with his team decides and plan the kind of resources required for the project. The organizer of the entire team and a negotiator to get the resources required for the project. The project manager also plays a role of a diplomat to make connections with the stakeholders and many others who are in anyway affecting the project to get their support. Apart from all of the above, it is vital for a project manager to have leadership ability. He creates the vision for the team and provides guidance in a participative style. Also, he needs to be appreciative and value the contributions of every team and should be a source of encouragement and motivation. In addition to all this, he needs to build an environment of trust and enjoyment so that the tasks do not become mundane for the team members. A capable project manager provides opportunity for learning and development by encouraging individuals to assume the initiative, take risks, and make decisions.( Clements/Gido, 2009, p.307). People, who are less experienced, learn from others and develop more skills at the end of the project. As project
  • 6.
    5 managers need tocommunicate effectively to their team it is imperative that they are good communicators. They should know how to share the information in a variety of ways. Also as they are the mediator between management and also have to prepare frequent reports. 4. RASCI This responsibility Matrix Structure in Project Prosalo has been used to assign tasks or deliverables to each role in the team. As there are four levels of accountability, Responsibility where in the team member who is assigned this role will have the responsibility to handle and achieve the particular task. This is followed by Accountable, the Individual who will be answerable for the activity will need to approve the work that member who is responsible does. Also for every task, there has to be just one role and not multiple with this level of responsibility. The team members who are assigned the consulted level are typically subject matter experts and others have to take their opinions to review the work. And then those member who need to be informed and made aware of progress should be notified to be notified as a form of one- way communication. 5. Team Development Team building and development are the act and process of forming, growing and improving the knowledge, skills and attitudes of individuals from different needs, organizational units and professional background, into a cohesive, motivated, dedicated high performance team. (David I.Cleland and Lewis R. Ireland, 2010, p.362 )The team of the project needs to include members with different expertise and qualifications to ensure they are motivated and can handle their tasks appropriately. There are five stages for developing a team out of which the first four were developed by Bruce Wayne. And later on, Tuckman along with Mary Ann Jensen introduced the fifth stage. The five Stages that will be used in developing a team for the PROSALO Project will be the folowing Forming This will be the first meeting for all teammates and they will be introduces to each other where they will share information about their backgrounds and experiences and will get acquainted with one another. The team will be formed and they will be introduced by the project manager to the project objective and roles they will be expected to play. In this stage the team will be completely dependent on the project manager to give direction and provide structure to the group. Team members are quite inquisitive during this stage. Also, the initial processes and procedures of the project will be defined for the various operations. Storming In this phase, the team members will be developing as a team. The team will now start to apply their skills and will compete for acceptance of their ideas. The Project manager can expect some conflicts during this stage as everyone will have different opinions. The need will arise for agreements on handling conflicts. In this stage the project manager needs to be less directive and provide clarification on roles and responsibilities of team members along with providing support and guidance Norming The team members now have started working together more effectively and the relationships between them have now become more settled and have accepted their operating environment. The sharing of ideas and information increases. The project manager
  • 7.
    6 is now moresupportive and less involved however they will make sure that the team works collaboratively and moves in the right direction Performing The team in this stage, has been consistently performing well and are focused on the goal as a team. A lot of progress has been made and is recognized so the satisfaction levels are very high. The attention of the project manager during this phase in on the progress and accomplishments and acts like a mentor for the team. Adjourning At the end of the project, the teams members will be moving off to new projects or jobs. The project manager should ensure that the success is celebrated and capture best work practices for future. 6. Escalation It is imperative for a project manager to monitor the project very closely in order to avoid any harm or delays to the project. Although the team will try and resolve issues internally there may be some serious issues that need the involvement of the upper management are vital to this stage. The manager needs to identify and evaluate the issue and realize what damage it can do and depending on the issue and can escalate it to the authorities for a timely resolution. The management needs to be made aware of the problem and such issues need higher priority. The approache to identify the criticality of the issue will be defined so that the roles can be distributed in advance to avoid any major issue that could impact the project. 7. Stakeholder Management It is vital to recognize the stakeholders who are in anyway involved or impacting the project. It is imperative to develop relationships with any person or an organization which can be your stakeholder at a very early stage of the project so that various techniques can be followed to analyze their influence and also then develop various strategies to manage and communicate with them effectively. Also It is important to communicate with the stakeholders on the regular level depending and develop constant links of communicating till the closing of the project. In this project, during the planning stage a stakeholder analysis was conducted in which we recognized our major stakeholders. Various steps were taken in this process like identification of various person or organizations and their role, needs and level of authority and how they could impact the project. In the planning stage, it was recognized with the help of past studies in similar projects that the Brussels Ministry of Environment as one of our major stakeholders as they have a very high power and an extremely high level Interest in the project as they approve our legal procedures to set up the office . We have very carefully examined there rules and regulations of the entire process and will be taking all the necessary actions to avoid any delays or concerns regarding getting the licensing and the permits. During the course of identification we realized that Media will play an important role in marketing and portraying the correct image of the new sales office in Brussels. Also they will be high in interest as this will be generating a lot of Job opportunities and will open a whole new market in Europe. Keeping in mind all the internal and external stakeholders it is understood that the Banks, Communities , Staff, Board of company are also a part of it, they will all be kept informed and of the project and will be under the constant communication.
  • 8.
    7 8. Reflection The importanceof learning project management cannot be emphasized enough. During the reading and learning phase it is realized that project management is a complex field which requires a lot skill set in every role. As the project manager plays the most important role being the head and the mediator between the sponsor and his team, how vital it is for him to have clear and effective communication skills. Also the balance of all the competencies is a key ingredient to successfully manage the project. They take a mission to deliver consistently and on time with the given budget and meet the expectations of the stakeholder and sponsors. And most importantly, the project managers rely on others for their success so they need to work in accordance with the whole team. The importance of clearly defining the responsibilities so the objective is more clear to every member is a challenging but an important task. References  Clements, James P., and Jack Gido. Effective Project Management. Mason, OH: South-Western Cengage Learning, 2012.  Cleland, David I., and Lewis R. Ireland. Project Manager's Portable Handbook. New York: McGraw-Hill, 2010.  Ottmann, Roland. The Naked Project Manager: A Book Based on Real-life Stories. Röthenbach, Nuremberg: Ottmann Et Partner, 2012.  PMI | Project Management Institute." PMI | Project Management Institute. N.p., n.d. Web. 11 Dec. 2016
  • 9.
    8 Table of Contents 2.Project Controller 2.1 Introduction 2.2 Roles and Responsibilities 2.3 Project Planning 2.4 Project Cost Management 2.5 Reflection
  • 10.
    9 2. Project Controller 2.1.Introduction Nowadays the work in project management is getting more complex, it seems like too demanding for the project manager to hold tons of things on their should at the same time. Project controller is therefore born for separating the duties from project manager in order to enhance the efficiency. This report is going to introduce how do I perform my role as a project controller in the project Prosalo and how does this position contribute to the project. The concepts and process of the works will be discussed deeply. 2.2. Roles and Responsibilities of Project Controller First of all it is important to know about the role of project controller in a project. Although the job duties of project controller is recently widely expanded and subdivided into many different category, they can be still briefly introduced as using scientific methodology and tools and also analytical skills to: 1) develop and maintain schedule, 2) estimate costs and draw up budget baseline, and 3) monitor the progress on project and forecast the impact of change (ACostE, 2007, p.11). 2.3. Project Planning Project Life Cycle and Milestones A project is a temporary endeavor which has a defined life span with a actual beginning and an end and contain a specific target to achieve (Melton & Trish, 2007, p.7). The period between the start and the end of a project is referred as project life cycle. Typically a project life cycle passes through four distinct stages: defining, planning, executing, and finally delivering (Lasson & Eric & Gary & Clifford, 2011, p.7). However, depending on the scale and scope of project, the life cycle can be expanded base on these 4 phases. The life cycle of Prosalo, apart from those 4 typical stages, “testing” is added in between executing stage and delivering stage in order to confirm the office is usable and all the employees are well-prepared for work as the team hope that the office can run smooth once it start operating. Therefore, Prosalo is a project which is based on a 5-phase-life-cycle. As mentioned before, one of the key role of project controller is planning and scheduling. The project life cycle makes a outline of Prosalo from beginning to delivery, but objectives of those stages are still missing. The final product of a project work is a bundle of success from each project phases, thus it is important to clarified the specific targets needed to achieve in every single stage. It is hard to have a plan or know what to do without expected output, those expected output of different stages are known as “Milestones”. Milestones are those events which are meaningful and significant for the project and need to be finished before going to the next step. They should be a solid event, or and
  • 11.
    10 object, because themilestones should tell the result of a phase but not a work which is pending to do. Normally there are at least 4 milestones in a project as the team have to achieve certain target otherwise the next stage can not be started. For instance, it is impossible to hire employees directly without any strategies and planning or delivery the office before finishing interior design. Besides indicating handover from one phase to the next phase, the importance of milestones is to provide “Control Gate” to the project. There is possibility that some of the deliverable are missed or the performance can not fulfill certain of standard. Milestones give a chance to the project team to have a review for the last stage to see if the project is suitable to continue to the next stage. If problems were found, the team have to determine how to tackle those problems. It could be accepting the problems, making improvement, changing objectives, or even stop the project if things go wrong seriously. The existence of milestones makes each phase of project as individual mini project and it is obviously easier for planning and controlling (Mike, Laurie, 2007, p.64). The quality of project can be ensured as deliverable and result would be reviewed at every milestone and appropriate action can be taken. After understanding the characteristic and functions of milestone, the project controller of Prosalo could start to think about which milestones should be included in the project. The objective of defining stage is basically same among all the projects. In this stage, the project management should understand ideas, concepts and requirement of the project and confirm the scope which will make benefits to the customer. Planning stage then comes after the defining stage. The target of Prosalo can be mainly divided into two parts - setting up a office in Brussels and hiring 12 young talented employees. As they are two totally different types of product, it is necessary to manage them separately. On the office side, the decisions of office planning should all been made including location, office needs and people who should be contacted such as government authority and contractors. On the other hand, decisions about hiring and training strategies should also been made at the end of the planning stage, which may include requirement of candidates, the flow of interview and training’s arrangement. The project management then go through the planning stage to the execution stage. Most of the products of Prosalo are expected to finish after this stage. There will be totally 4 milestones here. Firstly, the office’s location should be settled, which means, all the contract and licensing work are accomplished. This is only a vacant office so the next objective is to have a usable office by interior design and furnishing. Furthermore, after some process of interviewing and hiring, 12 young and talented employees are hired. Training and exam will then be provided to ensure their ability in the future career so the employees are all well-prepared at the end of the execution stage. The final milestone, also as the final product of Prosalo, the office will be delivered to WING at the closure stage.
  • 12.
    11 Milestones are onlydelegate to the targets which are expected to reach at different phases. In order to give better understanding about such milestones to the project management, project specific phases should be made to serve as a supportive document. It shows some specific information and description of the milestones such as major activities, duration, decision have to make and resources which are needed. The project team will then be clear about the objectives they need to achieve and more importantly, this document provides the main sources for the Work Breakdown Structure (WBS). Scheduling and Time Reserve Apart from phases and milestones, another essential element for forming project schedule is duration estimating. The project team need to estimate how much time they need for reaching each milestones and ensure the whole project can be finished timely within 26 weeks - quite a short period. To help in estimating the duration as accurate as possible, some steps and methods can be used here. The project team firstly have to think about the resources which can be used such as manpower. Even this is a elite team, 5 people cannot manage too much work at the same time. Information research can also be a way for time estimating. Big company often maintain a database to record the historical information. Those records, which are from the similar activities, can be taken as reference or basis of estimating (e.g. how long does the government authority take to respond requests) (Project Management Institute, 2000, p.77). Thirdly, it is necessary to work together with the risk manager to identify risks. The impact of risks mostly influence duration of time. Once a risk is identified as high possibility and high impact, more time should be given to the related work for any eventualities. The project team could choose to make a good use of time buffer as a cushion of unexpected delay. Concepts of time reserve will be discussed later in the next paragraph. The result of duration estimating is presented graphically by a Gannt Chart (see Figure 1). This is also the top level schedule of Prosalo. There are other ways to display project schedule but Gannt Chart is the most popular one as it contain all the information (start and end date, duration, phases, milestones) in a easy format to read. With the schedule and WBS, the project team now may know clearly about what, when, who, where and how the project is going to be done.
  • 13.
    12 (Fig 1. TopLevel Schedule of Prosalo) No matter how much effort have been put on the duration estimating, the project schedule is still only an assumption. There are many factors which may cause potential delay to the project and the project team can never guarantee timely completion of the project. Therefore, time buffer (or time reserve) should be applied to raise the probability of finishing project on time. Mainly there are two ways to find buffers - they can be feed into the project schedule intentionally by starting all activities as early as possible, which is called Critical Chain Management; another one is to discover buffers by network path computation, which is known as Critical Path Method and the following paragraph will be focusing on this method. As mentioned before, the final product of a project is normally a result of two or more small achievement. These achievement have different start and end point and go forward by their own path. It is almost impossible all the milestones are reached at the same time so the duration of each path can be very different. Even some of the milestones can be reached relatively earlier, they still need to wait for the the result of the long path, otherwise the project can’t go to the next step. There are two main path of Prosalo, one is office setting and another is employees hiring. Office setting needs longer duration because of waiting for respond of government authority, licensing and interior design, while employees hiring takes shorter time as interviewing is not a complicated process. However, although all the employees can be hired in a short time, exam can only be given them once the office is well-prepared and usable. The period that one path need to wait until another path to finish is known as slack. The path with the longest duration is called critical path as there are no slack you can find in this path (Fahad, 2014). Let’s say duration of the critical path in Prosalo (office setting) would last for 13 weeks, and duration of hiring new employees is just 6 weeks. If they both start at the same point, the path of hiring employees would have 7-weeks-slack before going to testing stage. Project team can therefore spare more resources to the critical path as it is tighter.
  • 14.
    13 With the CriticalPath Method, project controller can then calculate the total and free slack’s number of different activities. Total slack means the amount of time that a activity can be delayed without delay the project completion date. Free slack means a activity can be delayed without delay the early start date. (Dennis, 2007, p.217) The forward pass approach generate the early start and early finish date (ES / EF) of all activities and the late start and late finish date (LS / LF) of activities can be calculated by backward pass approach. After doing some simple calculation with the ES / EF and LS / LF then we can get the amount of total slack and free slack. Actually the Critical Path Method is not a perfect way to deal with potential delay. The emphasis of this tool is to find out the slack from non-critical path and allocate resources to the critical path. However, this is optimistically expect all the resources are available all the time. On the other hand, the activities lying on the critical path have no buffer at all, even they got more resources from the project team, it is still a challenge to finish those works within the duration. But still the Critical Path Method is an ideal tool for Prosalo as it draws special attention to the critical path and it is good for contingency planning and controlling the project which is not so complicated like Prosalo (Fahad, 2014). Last but not least, the resources needed to use in this project are not so much, resource dependencies is therefore not a problem. 2.4. Project Cost Management Project Cost Estimating and Baseline - Challenges and Limitation The importance of cost to a project do not have to mention specifically. Project controller not only need to calculate the cost of needed resources, but also decide how much cost should be spent on a activity depending on it’s estimated effect. Cost of project mainly come from resources. The first step of cost estimating is to determine what kind of resources are needed (e.g. people, equipment, materials), quantities of those resources will be used and which activities would need them. Milestones, WBS and historical information are the main input to determine needed resources (Project Management Institute, 2000, p.85). Project controller should discuss with quality manager about the scope of project as different objectives may need particular resources to fulfill in order to maintain the quality of the project. Once defined all the resources the project need, cost estimating can be started. This is a challenging work because of different limitation. Ideally project controller need to estimate the cost of all resources, and then allocate them to different work packages to get a project cost baseline. Project Manager will hand in the budget plan to the management in order to request for budget. However, in
  • 15.
    14 reality, the sequenceis always reversed. The management will firstly provide the project team a certain amount of budget and the team have to decide how to allocate the budget, and Prosalo is one of the case. On the other hand, project team need to think about the balance between those 3 factors in the project triangle. When project controller try to reduce project cost, there will always be conflict against time and scope. For example, hiring one IT technician is definitely cheaper than hiring two, but the time for setting up computer and network will probably increase. Cost can also be reduced by canceling the exam, but then the quality will be a doubt. Project controller should have a good communication with quality manager because time and performance are always prior to cost (within budget is okay) in their perspective. Nevertheless, cost estimating and budgeting are still needed so project manager can gain more budget from the management in case it is necessary. The approach that Prosalo used is call Analogous estimating(see Figure 2). This technique is also called top-down estimating. Basis of top-down estimating come from previous project which is similar to Prosalo. Estimator refer to the numbers of previous project to determine the project total cost (Dennis, 2007, p.55). Generally speaking, this technique is base on experience and information. Top-down estimating is especially good for the initial stage of the project as no one has detailed idea about which resources are going to be used (Larson, 2011, p.132). But the low accuracy is a huge drawback - basically top-down estimate is a kind of “guesstimate”. Firstly, it is unusual that a previous project exactly same as the current project. Maybe there are some cases which are also about setting up a office, but Prosalo is quite special, which is a project aiming to set up a sales office in Brussels (the rent in Brussels is high) with a showcase room. Thus it is hard to estimate the cost of Prosalo by referencing other projects. Secondly, project team may not be familiar with all the aspects of the project. There are none of the team member has the expertise and experience in dealing construction work and interior design. The estimated cost of this activity is totally base on information from internet. No one knows if it is correct, or to what extent it is accurate. Because of the low accuracy, it is a challenge for the project manager to gain more budget as the details can not be provided to the management.
  • 16.
    15 (Fig 2. Top-downcost estimating using WBS) Concepts of Bottom-Up Estimating There is another approach which is more efficient and accurate call bottom-up estimating. This approach involves in the work package level and estimate the cost of individual activities. These individual cost will then be rolled up to bring about a project total cost (Dennis, 2007, p.55). The bottom-up estimating method is more reliable because it is on the basis of the WBS. Cost are more in detail and false can be minimized. Three things have to be aware in order to raise the accuracy of the result. First of all, project team have to define resource requirement as detail as possible. Secondly, all the team members should join the estimating. The team member who are responsible for one specific activity have to do the cost estimating for such activity because he/she is familiar with it. Of course it will be even better if the team member have relative knowledge or experience of that activity (Larson, 2011, p.132). Thirdly, bottom-up estimating raise not only accuracy but also cost, project team have to make a balance between additional accuracy and additional cost (Project Management Institute, 2000, p.88). Budget Reserve In order to tackle with identified and unforeseen risks, project controller also need to make cost reserve by cooperating with the risk manager. Risk manager will first find out and define the potential risk. According to the probability and harmfulness of the risks, fund will be allocated to different work
  • 17.
    16 packages, this isbudget reserve. There is a per cent amount of total budget putting on the top level of the whole project to cover unforeseen risks and it call management reserve. 2.5. Reflection Though the process is full of challenges, I am still very happy and enjoy a lot of of being the project controller of Prosalo. This project gives me a new understanding for planning. In the past the only concept about time in my mind is “deadline”. Finishing the job before the deadline means requirement fulfilled. But works will be getting larger and more complicated with my position going higher, sometimes the project is like a bottomless pit. Tools and techniques like phases, milestones and time estimating would be very helpful to organize and control time. They are important because they tell you what you have to do next and how you can reach the goal. Thus they are actually useful in many aspect on the daily life in addition to only project management. On the other hand, at the beginning I was worry about my position as one of the ability that project controller may have is strong sense on number, unfortunately this is what I am exactly weak in. Scheduling and cost estimating include a lot numbers and they make me stick there for a period a time. But in fact the difficulty come from the concepts behind those numbers, the calculation is just simple mathematics. People can always benefit from doing something they are not so familiar with because of attempting and delving into the new thing. I am glad that finally I am not only able to finish the scheduling and cost estimating, but also giving my analysis of those method to show that I really learn something therefrom. Honestly speaking there are many defects of this project. Mistakes can be made as this is our first project management, but still it is necessary to know what can be improve in order to strive for better next time. 1. The time schedule seems too optimistic. We will start to hire employees while at the same time we start the task of office setting. Ideally, communication with the government and signing contract would not spend much of time so we are able to manage other things. But no one knows if this assumption is correct or not. It is better to ask for opinion from someone who are experiencing or do more information research. 2. The Critical Path Method is not so secure. Although the critical path have the first priority for using resources, it has no slack to against risks and uncertainty. And the assumption of unlimited resources is too optimistic. Therefore, using the Critical Chain Management would be a better option. This approach is more realistic and encourage us to work efficiently. 3. The top-down cost estimating is too rough. Lack of knowledge and information is a reason, but the team can do more on thinking about the needed resources and duration. Even the top-down approach is about guess, the more preparation you do, the higher accuracy you get.
  • 18.
    17 Bibliography Books Dennis Lock, 2007.Project Management. Gower Publishing, 9th Revised Edition. Larson, W. Eric, Gray, Clifford F., 2011. Project Management. The Managerial Process. McGraw-Hill, 5th International Edition. Melton, Trish, 2007. Project Management Toolkit: The Basics for Project Success. Butterworth Heinemann, 2nd Revised edition Mike Field, Laurie S. Keller, 2007. Project Management. Thomson Learning. Project Management Institute, 2000. A Guide to the Project Management Body of Knowledge (PMBOK® Guide), Project Management Institute, Inc., Pennsylvania, 5th Edition Article ACostE, 2007. Reining in your project controls - introducing the Project Controller. Project Control Professional, May 2007, p.10-13. Internet Source Fahad Usmani, 2014. Critical Path Method (CPM) in Project Management. Retrieved from https://pmstudycircle.com/2014/01/critical-path-method-cpm-in-project-management/
  • 19.
    18 Table of Contents 1.Introduction 2. Quality Management Approach 3. Project Manager’s responsibilities 4. Project Priorities 5. Quality Assurance Plan 6. Review Plan 7. Reflection 8. Appendix
  • 20.
    19 Quality Management Introduction: This qualitymanagement plan helps to define the level of quality to be maintained during processes of the project and is backed up by requirements. It also describes the procedures by which the project team will maintain the required level of quality in its work process, work packages, cost budgeting, and deliverables. The goal is to maintain the Quality of work and produce results that go beyond requirements. Following are the specific requirements of this project.  Setting up Sales office in Prosalo  Hiring 12 young professional employees  € 150,0000 for total cost  Time period for the project is 26 weeks It is important to define what actually mean by quality in this project operationally. Quality in this project is defined as “Setting up an sales office in a great location with infra-structure that is best suited to young professional employees and their work environment within time frame.” The aim is to hire twelve highly professional and competent employees, providing high quality training to them and also providing certificates. This Quality Management Plan for the PROSALO project will help to establish the activities in processes, setting up procedures for maintaining the quality of projected work and services rendered to the WING upon the completion of the project. Quality Management Approach: This portion portrays the approach that will be adopted to manage quality in entire project. Quality management is essential to prevent un-necessary wastage of time and cost while providing desired deliverables in the project. This quality management plan follows approach from “Process Quality” in which quality is checked and maintained in time to time basis. This quality management plan is based on following considerations.  Priorities  Quality Assurance/ Required Actions  Review Plan  Reflection In order to ensure best quality, this Quality management plan describes various procedures following which the project will be successful, the procedures are:  Scheduling meetings  Managing resources ( out sourcing , hiring procedure, testing instruments )  Cost review  Time analysis  Checking with buffers in time/budget  Feedback/ suggestions from employees
  • 21.
    20 Project Manager’s Responsibilities Project Manager: Planning and Defining Scope. Activity Planning and Sequencing  Project Controller: Working with project manager, clarifying objective and goal of the project , creating project budget and schedule.  Quality Manager: Working with project that fits with the office’s internal and external requirements, also with legal compliance and office expectation. The main focus of quality manager is to ensure that products meet certain quality standards. They plan, direct or coordinate quality assurance programs and formulate policies for quality control. Their goal is to improve the organization's efficiency and profitability by reducing wastage of time and cost and maintaining high level of performance.  Risk Manager: working with project loss control, finance, claims specialists, legal issues and accounting  System Architect: working with project behavior and structure Priorities: This project has diverse priorities according to the set milestones. At initial/planning phase, this project focuses more on performance. At second stage/Operations mode, project members will focus more on time. At the last stage/ testing phase, team members will focus more on cost. Over all, all three priorities will be considered throughout the project according to the need of the situation and project dynamics. Quality Assurance Plan: Having already defined the term "Quality" for this project, the Quality Assurance Plan includes, sticking to the quality control process by taking required actions at the required times that are as follows:  Continuously conducting meetings with other leading members of the project.  Reducing communication gap and providing free access to important information and details about the project and also facilitating communication between the leading members of the project.  Preparing audit report of budget so that this project will not exceed the required limit.  Checking real-time milestones in order to ensure that project is going on within the time frame and the deadlines are being met.  Trying to figure out and alleviating reasons, if any member of the project is not satisfied with project operations or any other factor.  Making necessary audit report for deliverables (Office, Professional employees, instruments ) against cost.  Testing Office infrastructure and employees capabilities ( after training )  Every manager will make report on his/her duties that reflects performance  Getting Feedback from fresh employees about office location, infrastructure, hiring process, and communication to their boss.
  • 22.
    21 Expected date tocarry out activities Date Activities Results 24th Nov 2016 Conduct meeting in order to reduce communication gap and introduce team mates and briefing of project’s requirements, quality standard and basic time frame. Positive 28th Nov 2016 Discuss in detail about Planning phase of project Positive 26th Dec 2016 Finalizing Office Planning Pending 16th Jan 2017 Finalizing Hiring Strategies and discussion in detail for operation phase Pending 6th Feb 2017 Reporting for office execution Pending 20th Feb 2017 Checking office Location with cost budgeting Pending 27th Mar 2017 Checking office infrastructure and compare to actual cost Pending 10th April 2017 Reporting for hiring process Pending 24th April 2017 Checking if hiring process is already done and discussion about testing employees and office infrastructure Pending 1st May 2017 Report of on-going testing procedure Pending 8th May 2017 Detailed report about testing phase from responsible persons and check with budget. If things are good, then discussion for handing over this office to WING Pending 12th May 2017 Be sure that all preparation is already made Pending 15th May 2017 Feedback from WING Pending Through these activities, the project will have desired deliverables in a condition where other factors such as time, cost and performance remain according to plan. On the contrary, if there is some problem then it is then responsibility of quality management team; specifically of the quality manager, that he makes alert log to identify the problem and take necessary steps in order to resolve the issue. This could be done through the below sample chart: Logs Date Type of Problem Responsible Authority Suggested ( Action/Solution ) Deliverables Time Cost Communication gap Review Plan: This section provides information about how this project is to be reviewed in order to reduce any mistakes/error. This could be done by the “Quality Manager “for his record. And if quality manager finds some problems in review plan then he should conduct meeting with other leading managers or with specific manager, depending on the issue and the person responsible. This must be documented in written form so that errors are corrected and responsible authority is approached to resolve this issue. This project manages review plan in a format that is shown below.
  • 23.
    22 Log Date Review ofactivities Problems Responsible Appointment Reflection: At the very first stage, when all team members were assigned to complete this project in an effective manner, all of them were not much familiar with terms “Work packages, Work breakdown structure, milestone, stake holder register”. But after having brief instructions about these terms, all team members are now well trained to cope with all kind of problems that may occur. In addition to this, the instructions polished team member’s internal potential for analyzing situations in a critical and serious manner. The Project manager was facing a problem in dealing with the sponsor but finally project manager succeeded in convincing the sponsor, reduced communication gap among all other leading team members. The System architect faced problems with short span of time but with the help of samples of other similar past projects, this project system architect managed everything in a very smooth manner. In general, all risk managers always find complications about legal documentation, but in this project, risk manager did an excellent job in drawing appropriate legal documents. Since this project has little budget, project controller encountered few difficulties while analyzing top to down budgeting approach and bottom to up budgeting approach but the project controller did tremendous efforts in order to meet requirements while keeping quality of deliverables. Quality manager was little bit confused in defining the term “Quality “in this project. But due to excessive amount of collaboration with other top level management, Quality manager was able to define “Quality “in this project in a right manner considering the requirements of projects.
  • 24.
    23 Appendix QUALITY There is awide variety of definitions of quality. Walter Stewart defined quality as the goodness of product. Later this definition was broadened and extended to both products and services. A query was conducted on numerous managers in the United States to state their definition of quality. The following nine definitions were the most popular: 1) Perfection 2) Consistency 3) Eliminating waste 4) Speed of delivery 5) Compliance with policies and procedures 6) Providing a good, usable product 7) Doing it right the first time 8) Delighting or pleasing customers 9) Total customer service and satisfaction (Evans 2008, pp.6) Quality management system (QMS) is a formal system that includes documenting the structure, responsibilities and processes required to achieve effective quality management. In addition, quality management is defined by American Society for Quality as follows: “The application of a quality management system in managing a process to achieve maximum customer satisfaction at the lowest overall cost to the organization while continuing to improve the process” (ASQ, 2013a). Reflection model: This model highlights that experiences in learning combine behavior, ideas and feelings and all of these aspects need to be examined in the process of reflection. (Boud, Keogh and Walker,1985).
  • 25.
    24 Table of Contents 4.Systems Architect 4.1 Use cases 4.2 Requirements Definition 4.3 Plan for Verification, Validation 4.4 Reflection References
  • 26.
    25 4.1 Use Cases ProjectBaseline Report As a “Systems Architect” of the project “PROSALO” who is responsible for looking for the tangible output in the view of user perspective, I determined to deliver the project not only to meet the needs but also satisfy all people operating the sales office after the end of the project. I do consider and concern the requirements from WING and also our young professional employees by using users’ stories as a tool to do the project more understandingly and effectively. The aim of my work is to closely coordinate with management team and put the role of “Systems Architect” during the project to monitor each process to achieve as planned. There are two major deliverables that require careful monitoring and verified testing before handing over to WING: a Sales office and 12 young professionals.
  • 27.
    26 “Sales office” According to“Top Level Schedule”, the decision regarding to office planning will be done first in LM2 (within 4 weeks). What should be done in this process is the project management team needs to clearly understand requirements and reach an agreement. Thus, everyone has a chance to propose ideas and clarify things to make sure we are on the same track during the planning. As a role of systems architect, location (2.1.1) and office needs (2.1.3) are my major tasks from Work Breakdown Structure (WBS). In planning process, the project management team and I as systems architect have come up with obvious requirements of the sales office as follows - Located in downtown area but not too showy - Enough space for showroom and 12 employees - Renting is in a budget - Able to make a contract within desired period of time For office needs, keeping in mind on users’ most benefits, it’s advantageous to list all utilities in each room which relates to the features and functions in order to easily hand on the list to a contractor to purchase all products with the requirements. Utilitty List Utilities Requirement Approx Cost Number Note Room: Kitchen 1.Table Spacious & Durable EURO 100 1 For 12 Pax 2.Chair Comfortable, Durable & Light EURO 10 Each 12 - 3.Coffee machine Italian brand EURO 200 1 -
  • 28.
    27 In the stepof execution for the office, I need to cooperate more with a quality manager during construction and design (3.1.3) to ensure standard and security of infrastructure. To do so, the strategy of our project is to do make a weekly report to check the advancement of the project and do “Initial testing” for things right away after installation to check such functions. However, the all verification of the office will be absolutely checked again during office testing (4.1) with the plan of verification and validation. Report Week 10 Construction And Design Installment Completion Initial Testing Quality Manager 1.Electricity Done 100% Verified ((Signature)) 2. Interior design On process 68% - - 3. Office utility 3.1. Table and Chair On process 10% - - “12 young professionals” According to “Top Level Schedule”, the decision regarding to hiring strategies will be finalized in LM3 (within 3 weeks). As a role of systems architect, requirements of employees (2.2.2) are my responsibility from Work Breakdown Structure (WBS). So, in order to support and assess young high potentials to participate in the project, it is necessary to set up appropriate job requirements to attract those who are ready and well qualified to join. - Male or female based in Brussels - Aged 22-25 years old - Bachelor’s degree or higher in Public Relations, marketing or any related fields - Fresh graduate is welcome - Good command of English in writing and speaking - Creative and critical skills - Green energy knowledge is a plus - 1-year contract With the assistance by quality control who examines the job requirements, I can conduct a good work. Fortunately, I also appreciate the help from risk manager who proposes on signing-a-contract condition to reduce employee turnover which will waste time and cost during the project if such cases occur. By the time of LM6 which employees will be hired, I have got 13 weeks since LM3 (Decision regarding to Hiring Strategies). After job postings, I would take responsiblity on recruting candidate and setting up interview (3.2.2) to secure WING to have right people working with. Ones who can pass through the interview process are those who show high enthusiasm on this job which means who are readiest and well qualified according to job requirements.
  • 29.
    28 Candidates who getthrough the interview sesion have to do written examination before the real interview with committee which comprises of a person from WING, one from MASA, Project Manager and me as a Systems Architect. Written examination would be psychometric and aptitude test related to each role of jobs (sales, accountants, secretaries) to assess the personality and characteristics of candidates match each job role. To illustrate, for sales officers we require those who obtain self motivated, strategic thinking, personal diplomacy and influencing on customers‘ decision. Eventually, to evaluate and find 12 young professional employees who fit PROSALO, those candidates have to impress all committee during the interview which we also agree on these extra requirements who can be obviously seen from such final criteria: hardworking, team player and creativity. 4.2 Requirements Definition A requirement is a formalized statement identifying a capability, a functionality, a physical characteristic, or a quality that must be met or possessed by a system or system component to satisfy a contract, a standard, a specification, or other formally imposed documents (ISO 10795, 2013) PROSALO is a challenging project which I prioritize the requirements in order to satisfy WING who anticipates the success of the project and facilitate employees who will operate the sale office in the future. To meet those needs from both sides, as a systems architect, I choose to have procedure to run on my work. Steps of requirements management 1. Identify requirements In every stage of work, we always start with the requirements of stakeholders who are WING and employees to know what their needs are. Also, it helps me to avoid last-minute requirements that may happen unexpectedly which will bring about risks to the project. 2. Manage the demand considering time, cost, scope + customer satisfaction After working based on requirements from stakeholders, the project should be executed under the triple constraint. For example, the office meets all requirements in terms of nice location, well- equipped office but it delays to hand over for a month or costs double of the budget. It is a failure. Thus, it is unavoidable to take strong consideration on time, cost, scope and especially customer satisfaction. 3. Review Eventually, each task of work needs to be reviewed whether it functions correctly or needs to be fixed. Otherwise, how does the defect or malfunction meet the requirements? As a result, an effective plan for verification and validation should be initiated.
  • 30.
    29 4.3 Plan forVerification, Validation Verification is to ratify that the system meets the requirements while validation is to ratify that the systems meet stakeholders’ needs and expectations. After we have done these steps, next is acceptance testing which allows us to coordinate with customers whether they accept the system and feel pleased to pay. Our plan is to have initial testing in execution (3) and completely huge verification and validation in testing (4). After each task in execution process has been done such as construction and design, in order to reduce uncertainty of an occurrence which will have an impact on the project, it is crucial to verify the system right away after the installation for example, electricity in the office, computers, and other office utilities. Then, the plan for verification, I as a systems architect I decided to adopt Verification Process: V- Model to run through the whole office testing (4.1) and examination (4.2) of new employees (after being trained) in testing (4). There four stages of verification process: inspection, review, analysis and test to double check the office, infrastructure, utility and new employees whether they meet requirements or not. Those which/who perform under the standard must be improved and verified again. (Prof. Dr. H. Meyer / Dipl.-Ing. Heinz-Josef Reher, 2012) Last but not least, if there’s still a problem, we need to work on that immediately with project management crew related to issues to find the best solutions for problems caused. And, when everything goes well, we could pass through to validation of the project to be ready to hand over on LM8 (one week before the duration of PROSALO).
  • 31.
    30 4.4 Reflection “Systems architect”is a person who dedicates a lot in this project. In my opinion, it is the person who focuses on how it is going to be used, how useful the stuff is, and how impressive the people who use it will feel. Apparently, what really helps me is “having the idea of user’s perspective” because if you know what their requirements or what they want, it gives you a clearer idea of what it is and how it looks like. What could be the problems during the project is “having too much the idea of user’s perspective”. The reason why I assume like that is when you care too much on customers’ requirements, it gives you hard work too. Sometimes, what they need cannot meet with the triple constraint such as real cost, limited time and scope (eg. scope creep). So, it should be well balanced. Finally, without coordinating much and keeping close contact with quality manager, project manager and the risk manager, I as being a systems architect wouldn’t perform the work successfully.
  • 32.
    31 References Dick Billows. ProjectRequirements. http://www.4pm.com/project-requirements-management, 2016. Accessed at November 30, 2016. Gerrit Muller. The Role and Task of the System Architect. http://www.gaudisite.nl/RoleSystemArchitectPaper.pdf, 2011. Accessed at December 3, 2016. Institute of Phychometric Coaching (IPC). http://www.psychometricinstitute.com.au/Managers- Sales-Business-Development.html, Accessed at December 2, 2016. ISO 10795. Requiremets Management. https://www.iso.org/obp/ui/#iso:std:iso:16404:ed-1:v1:en, 2013. Accessed at November 29. 2016.
  • 33.
    32 Table of Contents Introduction 5.Risk manager Case study: Prosalo Role of risk manager 5. 1 Risk description 5.1.1 Risk management planning 5.1.2 Probability and impact 5. 2 Risk evaluation and portfolio 5.3 Risk strategy and mitigation plan 5.4 Reflection References Appendix
  • 34.
    33 Introduction Risk is presentin all projects on a small or large scale. It has, in most cases, a very negative connotation and avoidance or reduction of risk seems to be the aimed course of action. Though risk is seen as undesirable, risk is inherent to most projects and without it new opportunities would be lost (Embrechts and al, 2015). A certain amount of risk is present in the completion of a project. Risk management in a project, in accordance to its main focus, is to be able to identify potential risks and then control the probability or impact or consequences of an event (The Institute of Risk Management, 2002). The specific branch of project management that caters to risk is called risk management and « is the processes whereby organisations methodically address the risks attaching to their activities with the goal of achieving sustained benefit within each activity and across the portfolio of all activities. » (The Institute of Risk Management, 2002) 5. Risk manager Case study: Prosalo Risk is specific to the case or project in which we are dealing. To fully understand what risks are possible in this particular case, a brief explanation will be made. The project consists of the opening of a new sales office in Brussels for a consulting company. The requirements for this new office, called Prosalo, in the framework of the project, consist of a time limit and a financial limit of 26 weeks and 150 000 €. At the end of this project, the deliverables are a fully functional office space ready for use, as well as, a fully trained team of twelve young professionals. This means that the office delivered must be ready to use and ready to make operational. Role of risk manager Seeing as each project presents its potential risks and potential issues, a risk manager is necessary to manage these situations. The role of a risk manager is to «advise organisations on any potential risks to the profitability or existence of the company. They identify and assess threats, put plans in place for if things go wrong and decide how to avoid, reduce or transfer risks (Halder, 2016).» What is important to remember is that a risk is not a problem, it is a potential situation that needs to be addressed.
  • 35.
    34 5. 1 Riskdescription 5.1.1 Risk management planning In order to manage your projects risks, a plan must be laid out. Initially, identification of risks needs to be done. In this stage, potential risks, causes and effects, tailored to the needs of your project, need to be identified. Risk triggers, which can be compared to warning signs, are things that can help you anticipate a possible risk to your project (Project management knowledge, 2016). After this, risk analysis is necessary: evaluation of the probability of occurrence and impacts of risk, creating a short list of most critical risks and evaluation of the feasibility and viability of the project fallowing the results. Thirdly, a risk response plan and strategy is put in place (Project management, class slides, 2016). 5.1.2 Probability and impact Importantly, at the beginning of the risk identification process, it is worthwhile, and crucial to set common guidelines for the team in terms of probability and impact and how to evaluate them. In the case of Prosalo, the scale for probability was set as follows: Low, medium, high, very high. Each of these categories represents a percentage class, meaning the possibility that an event will occur out of one hundred (Table 1). Table 1: Evaluation of probability of risks in percentage Probability Occurrence probabilities (%) Low 1-25 Medium 26-50 High 51-74 Very high 75-100 As for the impact, it too will have a scale set as follows: Low, medium, high, very high. In this case, three distinct categories can be affected. These categories refer to the triple constraints: Performance, cost and schedule (time) (Table 2). Table 2: Evaluation of impact of risk with performance, cost and schedule constraints Performance Cost Schedule Impact Achievement of requirements Increase in developmental costs Delay Low Errors only perceived < 5K € < 2 weeks
  • 36.
    35 internally (Prosalo) Medium Slightly degraded performance ≥5K € to < 40K € ≥ 2 weeks to < 6 weeks High Significant impact of performance, inability to deliver the project on time ≥ 40K € to < 65K € ≥6 weeks to < 8 weeks Very High Endangering the mission of the project and feasibility of delivering office ≥ 65K ≥ 8 weeks Once the risk probabilities and impacts determined and evaluated, the risk level can be determined. Once the risk level is clear, a certain prioritization can take place (Appendix 1). These levels will also help plan responses to be taken in terms of the different risks (Project management, class slides 2016). 5. 2 Risk evaluation and portfolio In terms of the Prosalo project, many risks where identified. Three of the main risks where the following delay in project approval and permits, technical issues with devices and employee turnover. A risk register was created for our project (Appendix 2). The first risk would be described as follows; if there is a delay in project approval and permits then the office delivery to WING will be delayed. The initial approval of the project will have to be given by government bodies. This step is very important because the continuation of the project is not possible without initial approval. Possible risk triggers for this are missing documents, changes in legal aspects, different legal aspects in different countries, translation necessities that may take time. The main constraint affected in this is time. Seeing as these approvals are a major concept in the Prosalo project the impact of this risk is high (inability to deliver the project on time and significant impact on overall performance of the project) and the probability is medium seeing as the amount of paperwork needed will be high and therefore necessitates more time to process. These impact and probability levels give an overall medium risk level. It is evaluated that the cost of this risk may be equivalent to a four week delay period. The risk owner to this problem is the project manager seeing as he or she will be the one in contact with government organizations. The second risk that of technical issues with devices; if there are technical issues on devices, then the employees cannot work in a supportive environment. The installation of such devices will take place during the execution phase of the project. This step will permit the office to be ready on
  • 37.
    36 time and operationalat the date of delivery. The trigger for this risk is the installation of devices in the office throughout the execution phase. The major effect is on cost and time and they are estimated to be of 2000 € and 2 weeks to fix any potential problems. The impact is therefore low because it is a problem that is only perceived internally. The probability is high seeing as a completely new technology and information system is being set up. These impact and probability levels give an overall low risk level. The risk owner to this problem is the system architect. The last risk identified it that of employee turnover during the process of the project which is to say during the hiring, training and post training phase before delivery of the office; if there is employee turnover, then it will be necessary to repeat the hiring process. The trigger to this problem is negative feedback given by the employee to the management team or trainer throughout or after the training process. The low number of employees hired (12 total) places this risk at a high impact level. If one employee leaves, a big part of the work force is gone. The major effect is in terms of cost and time and they are estimated to be of 1500 € and 4 weeks to fix any potential problems because of the necessity to train a new person. The probability of this happening is low seeing as all employees will be made aware of the implications of the job at the time of interviewing and hiring. The overall risk level is therefore low. The risk owner to this problem is the quality manager. 5.3 Risk strategy and mitigation plan Strategies have been put in place to respond to each of the risks identified. Strategies are present in order to make informed decisions about the steps to be taken to manage risk. The strategy is there to help reduce the impact and/or the probability of a certain risk (Project management, class slides, 2016). In the case of the first risk identified, delay in project approval and permits, the response strategy to be taken would be acceptation and reduction of risk. Seeing as a part of this process is in the hands of an institution that is exterior to the project, part of this risk is harder to manage. This is where accepting of the possible outcome will take place. However, steps will be taken at the beginning of this process in order to reduce the risk of this occurring. Making sure all necessary documents are present and in order, making sure all translations of documents are available and all legal requirements are met are the steps that will be undertaken. In the case of the second risk, technical issues with devices, the response strategy is reducing the risk probability. Once the planning phase and the office setup is complete, set up of electronics and technological services will begin as soon as possible before official opening. This will reduce the
  • 38.
    37 chances of lastminute problems. Also, the devices and software will be tested in phases after each installation in order to avoid problems at the end and having to start the whole process over. In the case of the last risk, employee turnover, the response strategy is reducing the risk probability. The way to address this risk is to create contracts that will be signed by the employees at the time of hiring giving a minimum employment time, for example one year. This way the desire to leave during the course of the project will be reduced. 5.4 Reflection The role of risk manager is very important in a project, it helps direct a project in the right way that will help minimize potential risks. The goal of a risk manager is to identify risks and try to minimize their impacts and probability. Though risk managers formulate risk registers and determine what strategies to use in order to achieve their goal, they do not work alone and every member of the project is vital to help him or her manage risk. Every risk falls under the responsibility of a member of the project and it is a team effort. As mentioned earlier, every risk identified in this project has a different risk owner that in every case is different than the risk manager. This shows that risk is in the hands of every member of the team. The risk manager therefore works closely with all other roles. It was identified that risk in projects can be internal or can have an external origins and the level of control you have over every aspect is not necessarily complete. Identifying these risks is, however, a key part of any project seeing as it permits you to overcome challenges, deliver projects on time with as little disturbances as possible and have control over the course of action that your project takes. The role of a risk management is therefore very important. This project has been very enlightening for us as future management professionals. It has permitted me to fully understand how and why it is important to plan and manage a project using the right tools. Tools such as the work breakdown structure, the master schedule, the risk register, the stakeholder register and the Gantt chart. Planning projects in this way permits you to have a clear goal or path during the project as well as helping you control different factors that could, without the proper tools, become confusing and poorly managed. In this way, you can have knowledge of the outcome and path that your project needs to take and avoid the unknown which can be a huge risk without project management. Project management is applicable in many areas, such as report writing, projects, working on organizational skills and working in team environments. This particular project context was very interesting because of the intercultural context of the class. Being able to see one situation through different points of view and different backgrounds was
  • 39.
    38 interesting and eyeopening. It permitted us to try and understand one another and work on our own strengths and weaknesses.
  • 40.
    39 References Embrechts, P., Frey,R. & McNeil, A. (2005) Quantitative risk management: Concepts, techniques and tools. PDF. New Jersey: Princeton University press. (Viewed on December 10th 2016) Halder, G. (2016) Job profile: Risk manager. Prospects.ac.uk. [Online] URL: https://www.prospects.ac.uk/job-profiles/risk-manager (Page consulted on November 30th 2016) Institute of risk management. (2002) A risk management standard. PDF. London. (Viewed on December 5th 2016) Investopedia. (2016) Risk Profile. Investopedia.com. [Online] URL: http://www.investopedia.com/terms/r/risk-profile.asp (Page consulted on December 5th ) Project management (2016) Slides MTM 2016: Risk management. Masters in international tourism management. Project management Knowledge. (2016) Triggers. Project-management-knowledge.com. [Online] URL: http://project-management-knowledge.com/definitions/t/triggers/ (Page consulted on November 30th )
  • 41.
  • 42.
    41 Appendix 2 Risk registerfor Prosalo Project Risk Risk Trigger Major Effects Impact Probability Risk level Strategy Action Risk Owner If there is a delay in project approval and permits then the office delivery to WING will be delayed Missing documents, changes in legal aspects, different legal aspects in different countries, translation difficulties Time High Medium Medium Accept and reduce Give in well prepared documents and make sure all necessary documents are present Project manager If there are technical issues on devices, then the employees cannot work in a supportive environment Installation of devices Time and money Low High Low Reduce Set up as soon as possible before official opening, Test the devices in phases after each installation System Architect If there is employee turnover, then we need to repeat the hiring process Negative feedback, desire to resign, insatisfaction of employee Time and money High Low Low Reduce Create contracts that will be signed by the employees at hiring giving a minimum employment time Quality manager
