Catalyzing New Mobility in Cities:
        The Case of Metro Manila
                              Project Launch

                      31 JANUARY 2012
          SOCIAL DEVELOPMENT COMPLEX AUDITORIUM
 ATENEO DE MANILA UNIVERSITY, LOYOLA HEIGHTS, QUEZON CITY
Catalyzing New Mobility in
Cities:
The Case of Metro Manila
Project Launch

31 January 2012
Social Development Complex, Ateneo de Manila University, Loyola Heights Quezon City

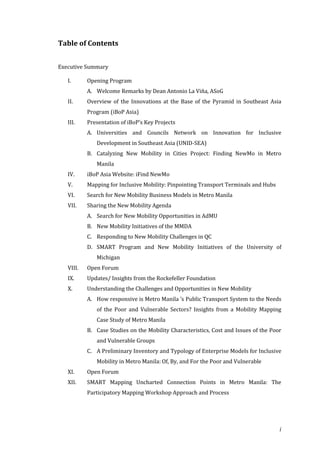

Table of Contents

Executive Summary

   I.      Opening Program
           A. Welcome Remarks by Dean Antonio La Viña, ASoG
   II.     Overview of the Innovations at the Base of the Pyramid in Southeast Asia
           Program (iBoP Asia)
   III.    Presentation of iBoP’s Key Projects
           A. Universities and Councils Network on Innovation for Inclusive
              Development in Southeast Asia (UNID-SEA)
           B. Catalyzing New Mobility in Cities Project: Finding NewMo in Metro
              Manila
   IV.     iBoP Asia Website: iFind NewMo
   V.      Mapping for Inclusive Mobility: Pinpointing Transport Terminals and Hubs
   VI.     Search for New Mobility Business Models in Metro Manila
   VII.    Sharing the New Mobility Agenda
           A. Search for New Mobility Opportunities in AdMU
           B. New Mobility Initiatives of the MMDA
           C. Responding to New Mobility Challenges in QC
           D. SMART Program and New Mobility Initiatives of the University of
              Michigan
   VIII.   Open Forum
   IX.     Updates/ Insights from the Rockefeller Foundation
   X.      Understanding the Challenges and Opportunities in New Mobility
           A. How responsive is Metro Manila ’s Public Transport System to the Needs
              of the Poor and Vulnerable Sectors? Insights from a Mobility Mapping
              Case Study of Metro Manila
           B. Case Studies on the Mobility Characteristics, Cost and Issues of the Poor
              and Vulnerable Groups
           C. A Preliminary Inventory and Typology of Enterprise Models for Inclusive
              Mobility in Metro Manila: Of, By, and For the Poor and Vulnerable
   XI.     Open Forum
   XII.    SMART Mapping Uncharted Connection Points in Metro Manila: The
           Participatory Mapping Workshop Approach and Process

                                                                                      i
XIII.   Annexes
        A. List of participants for Project Launch
        B. Moving Metro Manila – Eagle Eyes by Dean Tony La Viña
        C. Overview of the Innovations at the Base of the Pyramid in Southeast Asia
             Program (iBoP Asia) Presentation slides
        D. Universities and Councils Network on Innovation for Inclusive
             Development in Southeast Asia (UNID-SEA) Presentation slides
        E. Catalyzing New Mobility in Cities Project: Finding NewMo in Metro
             Manila Presentation slides
        F. Mapping for Inclusive Mobility: Pinpointing Transport Terminals and
             Hubs Presentation slides
        G. Search for New Mobility Business Models in Metro Manila Presentation
             slides
        H. New Mobility Initiatives of the MMDA Presentation slides
        I.   Responding to New Mobility Challenges in QC Presentation slides
        J.   SMART Program and New Mobility Initiatives of the University of
             Michigan Presentation slides
        K. Updates/ Insights from the Rockefeller Foundation Presentation slides
        L. How responsive is Metro Manila ’s Public Transport System to the Needs
             of the Poor and Vulnerable Sectors? Insights from a Mobility Mapping
             Case Study of Metro Manila Presentation slides
        M. Case Studies on the Mobility Characteristics, Cost and Issues of the Poor
             and Vulnerable Groups Presentation slides
        N. A Preliminary Inventory and Typology of Enterprise Models for Inclusive
             Mobility in Metro Manila: Of, By, and For the Poor and Vulnerable
             Presentation slides
        O. Photo Documentation

                                                                                   ii

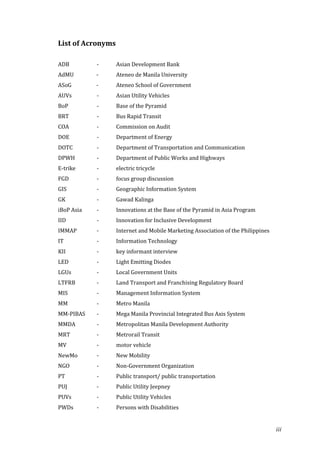

List of Acronyms

ADB         -      Asian Development Bank
AdMU        -      Ateneo de Manila University
ASoG        -      Ateneo School of Government
AUVs        -      Asian Utility Vehicles
BoP         -      Base of the Pyramid
BRT         -      Bus Rapid Transit
COA         -      Commission on Audit
DOE         -      Department of Energy
DOTC        -      Department of Transportation and Communication
DPWH        -      Department of Public Works and Highways
E-trike     -      electric tricycle
FGD         -      focus group discussion
GIS         -      Geographic Information System
GK          -      Gawad Kalinga
iBoP Asia   -      Innovations at the Base of the Pyramid in Asia Program
IID         -      Innovation for Inclusive Development
IMMAP       -      Internet and Mobile Marketing Association of the Philippines
IT          -      Information Technology
KII         -      key informant interview
LED         -      Light Emitting Diodes
LGUs        -      Local Government Units
LTFRB       -      Land Transport and Franchising Regulatory Board
MIS         -      Management Information System
MM          -      Metro Manila
MM-PIBAS    -      Mega Manila Provincial Integrated Bus Axis System
MMDA        -      Metropolitan Manila Development Authority
MRT         -      Metrorail Transit
MV          -      motor vehicle
NewMo       -      New Mobility
NGO         -      Non-Government Organization
PT          -      Public transport/ public transportation
PUJ         -      Public Utility Jeepney
PUVs        -      Public Utility Vehicles
PWDs        -      Persons with Disabilities

                                                                                  iii
QC            -   Quezon City
RnD           -   Research and Development
SE            -   Social Enterprise
SEA           -   Southeast Asia
TAN           -   Transparency and Accountability Network
TODA          -   Tricycle Operators and Drivers Association
UNIID     -       Universities and Councils Network on Innovation for Inclusive
                  Development
UP-NCTS   -       University of the Philippines National Center for Transportation
                  Studies
US            -   United States

                                                                                iv
Executive Summary

A total of 41 various organizations and 104 individuals working on transportation in
Metro Manila attended the project launch held last 31 January 2012 at the Social
Development Complex Auditorium of the Ateneo de Manila University attended the
launching of the “Catalyzing New Mobility in Cities: the Case of Metro Manila” project.
With support from the Rockefeller Foundation, this undertaking was organized by the
Innovations at the Base of the Pyramid in Asia (iBoP Asia) Program of the Ateneo School
of Government.

The aim of the launch is for the stakeholders to look at the big picture and see how
organization and infrastructure are connected and how these can make the difference. It
is a paradigm shift of looking at how people really move and how one can make a
difference. It is strong on having options that includes walking and cycling. The project
hopes to ignite the goal of sustaining a conversation among stakeholders on how
citizens can be empowered to shape the patterns of mobility and access in Metro Manila
to be more inclusive. It is expected that the Metro Manila stakeholders, are motivated to
actively contribute to their own enhanced mobility by taking advantage of the
constituency-awareness, -building, and -mobilizing opportunities presented at the
project launch.

The earlier insights of the iBoP Program were people say no to innovation because of
the price they had to pay for making change happen and that universities are not geared
toward the promotion of innovation because they are too divided into multi-disciplinary
silos thus, could not fuse themselves together.

With the initial results of commissioned researches in New Mobility project, the
following were some of the understanding of those on the ground about innovation: 1)
that the community was being census and may be asked to move out from their place;
and 2) the project might lead to improvements that might attract informal settlers from
other areas. These two experiences on the ground made the project team realize that the
community is afraid of progress and that the burden of understanding is with the project
people and not that of those in the base of the pyramid.

Some important highlights of the New Mobility project include:

   1. New Mobility Forum/Workshop/Lecture Series that serves as a venue for people
      to habitually share information, ideas, insights, and initiatives for taking action
      at a community level and increase advocates for mobility and access to
      transportation in Metro Manila.

   2. The project has a research component that seeks to explore the impact of the
      current public transport system especially the poor and the vulnerable
      population of Metro Manila by mapping the current public transport system and
      understanding the mobility patterns, cost and issues of the poor and the
      vulnerable groups.

   3. The search for New Mobility Business Models: New Mobility Social Enterprise
      and Social Innovations Award where the project will accept related initiatives,
      concept, ideas and solutions specifically addressing mobility problems in Metro
      Manila.
4. iFind New Mobility webpage in the iBoP website that features everything or
      anything related to new mobility including blog entries, links to other websites,
      latest news on mobility and an update of project’s activities.

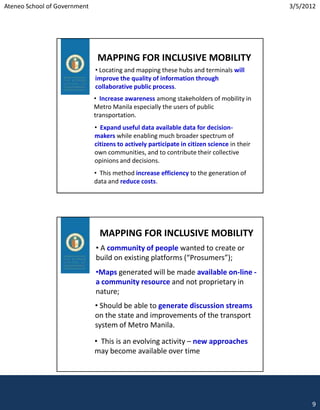

   5. Mapping for inclusive mobility: pinpointing public transport terminals and hubs
      using the hi-touch and hi-tech methods can improve the quality of information
      through a collaborative process. These also increases awareness among
      stakeholders, expand useful data available data for decision makers while
      enabling much broader spectrum of citizens to actively participate in citizen
      science in their own communities and to contribute their collective opinions and
      decisions. Hopefully these methods would increase efficiency to the generation
      of data and reduce costs while creating a community of people building on
      existing platforms. The information generated will be available on-line, not
      proprietary, and should start discussion streams on the state and improvements
      of the transport system in Metro Manila.

Other partners and stakeholders also shared their respective new mobility agenda as
follows:

   1. The Ateneo de Manila University presented by the University President, Fr. Jose
      Ramon Villarin, shared its vision of making the campus a sustainably mobile
      campus and its hopes of making it a carless campus. He also shared that there
      are plans for pedestrianizing the campus and starts including talks on mobility
      especially with students specializing on environment

   2. The Metropolitan Manila Development Authority Chairman Francis Tolentino
      presented all their projects that address new mobility issues in Metro Manila.
      Some of their key projects include: construction of bicycle lanes from Remedios

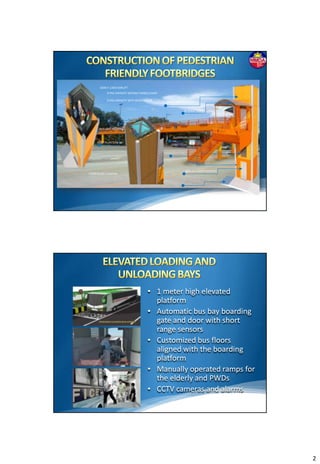

      Circle to Intramuros, construction of pedestrian friendly foot bridge to be piloted
      in Sucat, elevated loading and unloading bus bays, motorcycle lanes along EDSA,
      LED Message Boards, Mega Manila Provincial Integrated Bus Axis System,
      Vehicle Tagging, Metro Manila Traffic Navigator, and the EDSA makeover project.
      He also noted the h importance of utilizing the esteros for transport purposes.

   3. The local government of Quezon City presented by Retired Brig. Gen. Elmo San
      Diego, Head of the Department of Public Order and Safety of Quezon City, shared
      the electric tricycles (e-trike) program in cooperation with the Department of

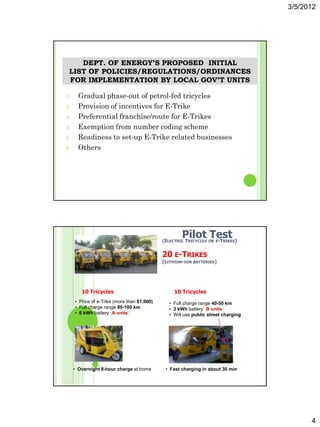

      Energy and Asian Development Bank. It is a rent-to-own nationwide program
      designed jointly by LGUs, DOE, ADB and government financing. The basic
      requirement is to trade conventional tricycle with e-trikes. He also shared the
      Open Katipunan (OK) project that they planned to implement with Ateneo.
      Ultimately, the goal of project OK is to reduce cars traversing along Katipunan in
      half.

Some of the issues/concerns raised by the participants were the following:

   1. The framing of the poor and vulnerable: The use of the terms “poor” and
      “vulnerable” versus “commuter” or “general public”. Whereas, “poor” is an
      economic condition while “vulnerability” is a physical and social condition. The
      poor and vulnerable should not be separated from the general public but be
      coiled into one term: “commuters”.
2. The operation of electric tricycles and how it improves mobility:Such as the cost
      of operation, what to do with the electronic waste generated in using lead acid
      for operation.

   3. The issues on making cities more walkable such as safety, health and
      monitoring.:Most of the mobility innovations are centered on vehicles despite
      the fact that walking is considered to be the most important mode of transport
      especially for the poor. Health-wise, make cities more walkable by also not
      endangering the health of the citizens.

   4. The idea of citizen or community involvement:Bringing action down to the
      barangay level might yield quicker and: better result than relying on government
      alone. The proper mind shift is that innovation is not always the government’s
      role. If the community can do something, they must act on it. Advocate for social
      accountability.

   5. The mapping components and its accessibility When mapping out transport
      hubs and terminals, consider the flood zone areas, sitios and barangays rather
      than street names and the vulnerable sectors like the senior citizens and persons
      with disabilities. In terms of accessibility, a discussion on all levels of access to
      information from gathering of data to publishing. Printed copies of the maps
      compared to posting on the internet may be more practical and are much
      acceptable to people.

In order to understand the challenges and opportunities of new mobility in Metro
Manila, preliminary data of the three commissioned case studies were presented. For
the mapping study, which tackles the question, how mapping can be used to respond to
the needs of the poor and vulnerable, Dr. Jun Castro presented both in numerical and
visual form partial mapping of the public terminals in North EDSA. In the study on
mobility characteristics, costs and issues of the poor and vulnerable groups, Mr.
Randolph Carreon showed photo documentation of their data gathering and general

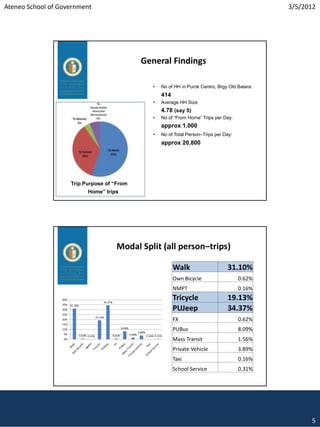

findings in Purok Centro, Matandang Balara, Quezon City. The data showed that people
primarily leave their house to go to work and school. Of the estimated total of 20,000
trips per day, aside from walking, the top 2 transport modes used are PUJ and tricycle.
Generally, the people said they would walk if they could. The perceived primary mobility
problem of the Purok Centro Matandang Balara community was high transport cost,
which they thought they could resolve by raising their income. Lastly, the Ateneo Center
for Social Entrepreneurship represented by Ms. Tieza Santos, is commissioned to look at
existing transport/ mobility related social entrepreneurship opportunities in the
transport sector presented a summary of pretest data gathering and recurring themes
and variables. Two recurring platforms were raised in terms of ICT access: mobile and
Internet. Based on the preliminary survey results, data showed that in terms of
affordability, these consumers are able to afford more information coming from mobile
technology and Internet. In terms of information services, they invest too much on
transport cost than service feature. In terms of willingness to pay, they are willing to pay
around PhP7. Majority have difficulty in availing healthcare services and the finding of
employment but the primary issue is not in terms of inaccessibility directly but more in
terms of actual cost of goods due to lack of employment. 77% attribute their difficulty
towards the cost of availing of these goods and services. The recurring themes that came
up were: 1) sustainable transportation related to sustainable targets and sustainable
legislation for transportation and land coordination policies/ designs, inter and intra-
agency collaboration approach, agency prioritization and allocation process; 2) Energy
efficiency, probably because of increasing oil prices and environmental health
consideration.
Ms. Susan Zielienski, Managing Director of the SMART Center University of Michigan
gave an overview of the SMART program and shared some of the new mobility
initiatives of the University of Michigan. She encouraged everyone to think of
accessibility (meeting needs) rather than mobility as the goal to open up a range of new
options for innovation, including IT. She highlighted that we all live in a world where
transportation is equated to cars hence, improving transportation means improving
cars. People are culturally connected to their cars that everything else becomes
extraneous. People assume that transportation is necessary, that cars are necessary,
therefore to improve on transportation, we must improve on cars. She asserted that life
would be much better if we have more choices and not just simply choose to have a car.
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                                   Project Launch
                                                                                  31 January 2012

     I.    Welcome Remarks
           Dr. Antonio La Viña, Dean, Ateneo School of Government

          The project launch of Catalyzing New Mobility in
      Cities in Metro Manila held in the Social Development
      Complex Auditorium inside Ateneo de Manila
      University started at around 9:00 a.m. with Ms. Marie
      Cddyqa Jaya Rogel of the Ateneo School of
      Government (ASoG) leading the Invocation and
      National Anthem. She welcomed the various
      participants    representing     different    transport
      organizations in the event. She then called Dr. Antonio
      La Viña, Dean of the ASoG, to give the welcome
      remarks.

          Dean La Viña welcomed the participants (See
      Annex A for list of participants) to the event and to the Ateneo de Manila University
      campus. He said that most of the things he had to say could be found in his column
      entry at The Manila Standard entitled New Mobility and Moving Metro Manila. He felt
      that moving Metro Manila was probably more important or equally important than
      what the country was facing in the judicial arena1 at that time.

          In his column article New Mobility, (See Annex B) he said that dealing with
      transportation in Metro Manila and getting it right is important for prosperity and in
      dealing with poverty. A mapping activity that aims to bring together stakeholders to
      the table and have a real good conversation about options with respect to
      transportation and a goal of making the people more mobile can be a good start.
      Making sure that the poor are not excluded in these conversations and decisions are
      also valuable in dealing with poverty. He ended by wishing everyone a fruitful
      discussion and a good day.

    II. Overview of the Innovations at the Base of the Pyramid in Southeast
        Asia Program (iBoP Asia)
          Dr. Segundo Joaquin Romero, Director, iBoP Asia Program

                                            Ms. Rogel introduced Dr. Segundo Joaquin
                                        Romero to present the iBoP Asia Program of the
                                        ASoG. (See Annex C for his presentation slides) Dr.
                                        Romero started by defining the base of the pyramid
                                        that started the iBoP concept. In his presentation of
                                        the world economic pyramid, base of the pyramid
                                        (BoP) was defined as people with annual per capita
                                        income of less than US $1,500.00. The iBoP uses the
                                        word “base” rather than “bottom” to refer to these
                                        people because bottom sounds too starved. He
                                        presented various data that further illustrates the
                                        base of the pyramid. The iBoP puts emphasis on their
                                        belief that low income does not mean no income and

1
    Impeachment trial of Supreme Court Chief Justice Renato Corona

                                                                                               1
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                         Project Launch
                                                                        31 January 2012

suggests a range of opportunities for market-based approaches to better meet their
needs and empower their entry into the formal economy. What the iBoP is trying to
do is to come up with a business model - similar to the New Mobility Project- that
focuses on the use of public social enterprises to cater to the need of the poor and
the vulnerable.

    The program started in 2007 with Dean La Viña spearheading the unique way of
putting together various disciplines and deploys them to engage BoP communities.
The program’s stakeholders include the government, private sector, non-
government and international sectors that work to engage the BoP sector in
Southeast Asia (SEA). ASoG houses the program and has existing partner
universities in Thailand, Indonesia and Vietnam and now plans to move to Cambodia
as well.

   SEA countries are very dynamic moving towards greater innovation. However,
iBoP is concerned that the innovation policies in SEA is more focused on economic
and industrial development and less on poverty alleviation. European countries
used serve as great models for innovation but increasing innovation capacity in
Thailand, Singapore and Malaysia are now being aspired by other with transport
being one of the major needs of the people.

    The iBoP currently pursues a two-track program or two major projects, the
Universities and Councils in Innovations for Inclusive Development in SEA and New
Mobility in Metro Manila. Dr. Romero also said that while the program is already
three years old, its people are new so relatively, iBoP is a new program with new
people.

    He also shared their early insights on innovation starting with a story of a Los
Baños farmer during Masagana ’99. This farmer was able to produce 100 kabans per
hectare through innovation but soon as he got his harvest, everyone went to ask for
a share of his yield. Incidentally, he had to continue giving even when he was at a
lost. The following year this farmer said no to innovation. He also shared another
story that happened to their conversation with the community at Purok Centro. At
the end of the workshop, the people raised two concerns: 1) that they were being
census and may be asked to move out from their place; and 2) the project might lead
to improvements that might attract informal settlers from other areas. These two
experiences on the ground made them realize that the community is afraid of
progress and that the burden of understanding is with the project people and not
that of those in the BoP.

    Second insight was that universities are not geared toward the promotion of
innovation because they are too divided into multi-disciplinary silos thus, could not
fuse themselves together. Dr. Romero encouraged everyone to participate in what
ASoG is currently doing and deploy together to promote innovation. He emphasized
that iBoP is about mind shift, not improve BoP directly but help create a mind shift
in the government and NGO sector.

                                                                                     2
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                                   Project Launch
                                                                                  31 January 2012

III.     Presentation of iBoP Asia’s Key Projects

    A. Universities and Councils Network on Innovation for Inclusive Development in
    Southeast Asia (UNID-SEA)
    Ms. Mary Grace Santos, Project Manager, UNIID-SEA

                                              Ms. Mary Grace Santos was introduced next to
                                         present the UNIID-SEA project of iBoP Asia. (See
                                         Annex D) It is a partnership project between the
                                         National Research Council of the Philippines and
                                         Canada International Research Center. To put the
                                         project in context, Ms. Santos said that SEA
                                         experiences show spectacular growth in poverty
                                         reduction over the last three decades; however there
                                         is a big trade off for this development as inequality is
                                         also rising. She also mentioned that the Philippines
                                         have the highest gini coefficient2 in SEA.

                                       She said that we are in the field of innovation
                                    where innovation is defined as the development of
    technology, products and systems that aim at making things easier and improve the
    standard of living. But in reality, innovation process tends to exclude the poor and
    the social challenges they face in the innovation targets, which further exacerbates
    poverty and inequality. Social justice, equality and human rights are not deeply
    embedded in innovation found in SEA. These innovations are mostly economic and
    industrial in nature. Human development are not really used or prioritized so social
    development is just secondary to economic, technological and industrial
    development in innovation policies.

        iBoP with UNIID-SEA advocates for a new perspective on innovation and
    development through IID. IID is understood as innovation that reduces poverty and
    enables many groups of people especially the poor and vulnerable to participate in
    decision making, create and actualize opportunities and share the benefits of
    development. In a nutshell, it is like democratizing development with innovation
    being knowledge and skill driven; the project will engage the key agents that
    facilitate the production, diffusion and application of knowledge for innovation in
    various fields: universities and research councils. It is innovation for all and by all.

        UNIID-SEA is a 3-year initiative (2012-2015). The idea was conceived by iBoP
    Asia of ASoG and IDRC to first facilitate universities and research councils’
    reinvention. Reinvention means to rethink, reorient, and retool to be capable
    intermediaries of innovation. For Universities, it is in teaching, research and
    extension and for research councils it is in priority/ agenda–setting, grant making
    with different minds coming together, and policy making. Second, the project seeks
    to facilitate the establishment of formal partnership and collaboration between
    universities and councils, which seeks to foster innovation research to reform social
    policy. Thirdly, the project aims to develop champions and nurture partnerships by

2
  Standard measure of equality in the world. Gini Coefficient: 0 representing perfect equality and 1
representing maximum inequality. Gini coefficients of SEA -- Singapore: 42.5; Philippines: 44;
Vietnam: 34.4; Malaysia: 37.9; Indonesia: 34.3 (Source: Securing the Present, Sharing the Future:
World Bank East Asia and Pacific Economic Update 2011)

                                                                                                       3
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                          Project Launch
                                                                         31 January 2012

forming a network and eventually connect to a global movement namely: UNIID
South Africa, Latin America and South Asia. In the long term, the project aspires to
foster multi-disciplinary, multi-stakeholder and multi-level (national, regional and
global) approaches, mechanisms and partnerships towards IID.

    The project will be working with one university each from Thailand, Indonesia
and Vietnam with ASoG being the lead university and project implementer in the
Philippines, in partnership with corresponding research councils for the next three
years.

    Ms. Santos also presented a quick run through of the activities the project will go
through or its components:

    a. Knowledge and capacity building (multi-disciplinary course module, Social
       Innovation Lab, capacity building workshop for champions);
    b. Research support;
    c. Link to policy; and
    d. Network building

   She invited everyone to the project launching this Aprilthat will bring in
representatives from all universities and councils ASoG will be working with. In the
end, she encouraged everyone to engage and participate as they develop the project.

B. Catalyzing New Mobility in Cities Project: Finding New Mobility in Metro
   Manila
   Dr. Marie Danielle Guillen, Manager, Catalyzing New Mobility in Cities Project

                               Dr. Guillen was called to present the new project
                           being launched on that day. (See Annex E) She started
                           with the background and purpose of the project, which
                           focuses on the use of new mobility as a lens in search of
                           more sustainable and innovative solutions in the urban
                           public transport system in Metro Manila, in particular,
                           ensuring that the needs of the poor and vulnerable are
                           met. Wanting to engage the participants, she asked them
                           what they meant by mobility and how each managed to
                           get to the event that day. Then she went through defining
                           the concepts involved:

                               Mobility – both the ability of a person (including the
                            goods that the community needs) to travel to
destinations of choice and the amount of movement and time necessary to do so.

    Transportation – the movement of people, animals and goods from one location
to another. The field is divided into infrastructure, vehicle and operations.

    New mobility in this project refers to an initiative that is multi-disciplinary,
multi-sector, top-bottom, bottom-up approaches like social enterprise innovations
in mobility addressing a socially inclusive transport sector. Multi-disciplinary means
that everyone is part of the transportation sector. She then recounted a story 10
years ago when she met a Japanese who inspired her to write a thesis on pedicabs
while her friend worked on cycling attitudes in the University of the Philippines.

                                                                                      4
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                          Project Launch
                                                                         31 January 2012

This meeting led to an understanding on the attitude to cycle. Basically the study
shows that built it and they will come. She highlighted that it took UP 7 years for the
system to have a car-free oval an infrastructure that would promote cycling.

    This New Mobility project is looking at improving the transport sector. It tries to
incorporate the dimension of sustainability in transportation such as social equity,
economic, financial, health, ecology, physical environment, air quality, noise and
climate change and not just focusing on traffic. This is based on the premise that as
complexity increases, the notion that a single solution to solve transportation
challenge also decreases and the need to look at the big picture. So there is a need
for everyone to be engaged in the call for new mobility and be catalyst, try to find
ways to solve these issues.

    Dr. Guillen then moved into differentiating some stakeholders involved in the
New Mobility project such as engineers, urban planners and IT developers. She
mentioned that everyone seems to do something to address the transport issues but
are not linked. There is a need to connect the dots and find out how each can link
together.

    The project aims to develop a new platform, resource center and enabler of
innovation for purposes of governance ensuring socially inclusive mobility in the
region. It also seeks to utilize and complement existing studies by initiating a metro-
wide conversation among stakeholders to introduce new mobility and find out how
the stakeholders envision the future of transport system in Metro Manila.

    Finding New Mobility in Metro Manila essentially means taking myriad steps
that leads to a paradigm shift by:

          Looking at the big picture;
          Focusing on people’s needs and wants especially that of the urban poor
           and the vulnerable groups; and
          Evolution of transport as attention turned to energy efficient mobility
           models, shared transport schemes and community owned transport.

     The project holds the Finding New Mobility Forum series called Let’s Talk New
Mobility. These series serves as a venue for people to habitually share information,
ideas, insights, and initiatives for taking action at a community level and increase
advocates for mobility and access to transportation in Metro Manila. She informed
everyone that a similar forum was held last October 2011 hosted by Ayala. She also
shared that they conducted validation workshops with the urban poor community
including tricycle operators and drivers association (TODA) to introduce the concept
of New Mobility and noticed that people got a bit worried but eventually relaxed
when they learned that this initiative is meant to focus on the people She further
shared that when they went on field, the community representatives shared that
they have no problem with road expansion but they were afraid that the New
Mobility project would dislocate them from their home. This misconception about
the project was corrected and the importance of road sharing for people as a way of
fixing things was emphasized. The goal of this forum series is to sustain a
conversation among these stakeholders on how citizens can be empowered to shape
the patterns of mobility and access in Metro Manila to be more inclusive. An
overriding aim is to promote other forms of public transport such as biking and
walking. These forum series want to highlight the fact that government is doing its
best to improve our transportation system and everyone needs a paradigm shift. She

                                                                                      5
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                           Project Launch
                                                                          31 January 2012

  mentioned that in our country people often use cars as incentive as we move up the
  economic ladder but in other countries they use public transport as incentive.

       The project has a research aspect that seeks to explore how the current public
  transport system affects the poor and the vulnerable populations of Metro Manila by
  mapping the current public transport system and understanding the mobility
  patterns, cost and issues of the poor and the vulnerable groups. Aside from learning
  all the issues, seeking new or emerging entrepreneurial or livelihood opportunities
  responsive to their mobility needs, Dr. Guillen reminded everyone that they do have
  a role to play.

      New Mobility also seeks to engage the general public. This activity aims to build
  a community of people wanting to create a platform or build on available platform to
  improve information generated in maps for seamless multi-modal connections. This
  is expected to benefit not only the poor and the vulnerable groups but the general
  public as well. The development of a mapping concept is needed to see the
  connectivity.

      The project also has the search for New Mobility Business Models: New Mobility
  Social Enterprise and Social Innovations Award, which has the following objectives:

            To surface enterprising solutions to solve social mobility problems;
            To engage different stakeholders in solving pressing mobility problems
             in the megacity especially that of the poor and the vulnerable sector; and
            To document existing social enterprises in the transport sector and
             generate innovative ideas that address mobility problems and needs.

      Then as prelude to the next speaker, Dr. Guillen said that the project basically
  attempts to generate inquiries, present more information, tickle the interest,
  insights of the people, initiatives, innovations and interconnections.

IV. iBoP Asia Website: iFind New Mobility
    Mr. Andre Quintos, Web and Networking Coordinator, iBoP Asia

      Mr. Quintos presented the iBoP Asia
  website (www.ibopasia.net) most specifically
  the new mobility section named iFind New
  Mobility. He started identifying the sections of
  the iBoP website home page with the header
  being a photo that illustrates the problem on
  new mobility. He said that the purpose of the
  New Mobility page on the site is to be a portal
  for everything related to new mobility. In the
  site you can find local and international
  content containing articles, blog posts and
  links to other websites. When users visit the
  website, they could immediately see the scope of what the website covers.

      iFind New Mobility is a blog where you can find anything related to new mobility.
  Latest news on new mobility can be found there. The sidebar on the right has links
  to other websites that help a typical commuter get around the metro, i.e. commuting
  in Metro Manila, MMDA, Metro Manila direction and ParaSaTabi.com. These links

                                                                                       6
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                            Project Launch
                                                                           31 January 2012

  can help commuters go from one place to another. The news and information page
  talks about the new mobility project and other project related events. Project
  Activity page would describe the activities of the project and explain what is
  happening. The Events page contains anything that happened in the past and has yet
  to happen. Mr. Quintos reported that he is working on a twitter feed to promote all
  the articles found in the website to the social networking site Twitter. Videos would
  be uploaded also on the New Mobility Watch page. The picture galleries of past
  events could also be found in the site, for example, the team’s recent visit to GK
  Village in Payatas.

      He informed everyone that the existing site is just the beginning and that data
  are being collected and placed online. He envisions the site to be more useful to
  people in the future by including a transportation map in real time using available
  open applications. He shared their plan of adding New Mobility Marketplace where
  people can post anything transport related they want to sell such as transport for
  sale, biofuel etc. Another possibility is to have a contest to get everyone engaged and
  hopefully help people learn about new mobility.

V. Mapping for Inclusive Mobility: Pinpointing Transport Terminals and
   Hubs
  Mr. Lorenzo Cordova, Jr. Research Associate, iBoP Asia

                                                       In order to understand mobility,
                                                   Mr. Cordova deemed it necessary for
                                                   all to look at three things: 1) the
                                                   different modes of transportation 2)
                                                   the factors affecting public transport
                                                   and 3) planning and advocacy. (See
                                                   Annex F) From a perspective of a
                                                   commuter, he presented the need to
                                                   pinpoint the public transportation
                                                   terminals and hubs and their
                                                   connection using a map to increase
                                                   mobility.

   The following were the key concepts of his presentation:

             Modes of public transport
             Public transport (PT) hubs
             PT terminals
             Informal transport hubs/terminals
             Engaging stakeholders in mapping

      He started by showing photos of the diverse modes of public transportation and
  said that each plays a major role in mobility especially of the poor and can either
  compete or play a complementary role to other forms of PT. He showed more photos
  of public transport hubs and multi-modal transport terminal in Metro Manila.
  Photos of PT terminals, mostly found in secondary roads, were also shown. Informal
  PT terminals/ hubs were defined as areas that are public or privately owned, used
  by motorized and non-motorized PT vehicles as terminals, but have no clear legal

                                                                                        7
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                          Project Launch
                                                                         31 January 2012

provision and/or local government ordinances that support its existence. However,
in reality, these informal PT terminals are often the source of living for the poor and
vulnerable.

    Why is it necessary to pinpoint PT terminals and hubs? One reason presented by
Mr. Cordova was the complexity and diversity transportation modes. Second is the
growing number of unaccounted PT terminals and hubs that hinders the walkability
and sometimes obstruct the flow of transport. Third, its existence is not a secret but
the country lacks readily available and accessible information where they are.
Fourth, LGUs and other government agencies lack capability to produce up-to-date
map and last but not the least, mapping requires much time and resources.

    In commuting in Metro Manila, do we think of connection points? What are our
choices and are they efficient? These questions were presented as the rationale why
we need to map transport terminals and hubs in Metro Manila. They are crucial in
order to assess the mobility problems and opportunities in Metro Manila and to
improve information generated in maps for seamless multi-modal interconnections
that would benefit not only the poor and the vulnerable groups but the general
public as well. The goal of mapping was to build a community of people wanting to
create that platform or build on available platform.

    He showed a mapping example of something they did in his GIS class to map the
tricycle terminals in Barangay Bagong Silang, Caloocan City. The violet dots,
representing the terminals, were all over the map (see Annex F, slide number 10).
According to the local tricycle regulatory unit in Caloocan, they said that the there
should be at least one terminal per one TODA but the map showed many tricycle
terminals located near each other. In his study, he found out that too much
transportation terminals and supply causes too much violence in the barangay. The
second map he showed (see Annex F, slide number 11) illustrates that most of the
terminals use up space for pedestrians and sidewalks thus reduces the walkability of
the barangay. This situation is not unique in Bagong Silang and can be found
anywhere in Metro Manila, thus the need for proper mobility mapping.

Mapping for inclusive mobility needs three major components:

          Individuals and organizations as contributors
          Intermediation platform – “enabler”
          Users

    Mobility mapping can either be done using “hi-tech” or “hi-touch” methods. Hi-
tech uses available open platform from the internet like google map or open street,
while hi-touch will be the one used on the New Mobility mapping workshop using
the University of Michigan-SMART Centre approach the following day. Hi-touch
method involves seven or more people in a group mapping and noting connections
and locations of specific terminals. He showed a listing of several existing web-based
platforms that can be utilized to map the terminals. Possible information from
stakeholders would include:

          Mode of public transport
          Location of terminal/ hub
          Name of TODA, JODA, PODA etc.
          Number of members

                                                                                      8
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                               Project Launch
                                                                              31 January 2012

                Destinations/ routes
                Time of operation
                Facilities and services available in the terminals/ hubs

          He gave a quick conceptual framework of how the project intends to map
      mobility. They wanted to form a community; utilize different platforms such as the
      Internet, mobile and hi-touch method; map out applications; and validate and
      hopefully be published online as a resource for the mobility of community.

           The project aims to improve the quality of information through a collaborative
      process, increase awareness among stakeholders, expand useful data available data
      for decision makers while enabling much broader spectrum of citizens to actively
      participate in citizen science in their own communities and to contribute their
      collective opinions and decisions. Hopefully the “hi-touch” method would increase
      efficiency to the generation of data and reduce costs.

          Generally, the project aims to empower a community of people that want to
      create or build on existing platforms. The community of empowered people will be
      producing data at the same time consuming them hence naming them “Prosumers”.
      He informed everyone present that the maps generated will be made available on-
      line as a community resource and should be able to generate discussion among
      stakeholders to improve state and improvement of the transport system in Metro
      Manila. He reminded everyone that mapping is an evolving activity so new
      approaches may become available over time. Finally, he said that everyone is
      welcome to give suggestions on how to improve their project.

VI.      Search for New Mobility Business Models in Metro Manila
       Ms. Jessica Dator-Bercilla, Senior Research Associate, iBoP Asia

                                        Ms. Dator-Bercilla started by asking who among
                                    the participants have tried walking and using public
                                    transport. She then asked whether the people from
                                    the audience ever thought that this experience of
                                    walking and/or using public transport would get
                                    better. She asked the audience whether any of them
                                    have written down or implemented their dream.

                                        She noted that many Filipinos lost the capacity to
                                     experiment and innovate soon after colonization. The
                                     psychology of Filipinos noted that Filipinos are too
                                     used to borrowing ideas or solutions from others
                                     (countries) that we forget to dream enough to
                                     experiment. But under the New Mobility project, this
      notion would be dissolved. A new business model search would be made open to all
      for their transport dreams to turn into reality.

          First she presented was the Social Innovation Initiative/ Concept Awards.
      (See Annex G) This opportunity is for those who have not written their idea on how
      to make urban centers more mobile. The project will accept concept, ideas and
      solutions specifically addressing mobility problems in Metro Manila. Essentially this
      is a solution-seeking initiative. The project is looking for innovative ideas under
      these four categories borrowed from the 4Ps of Innovation by John Besseant and Joe
      Tidd of the Humanitarian Fund:

                                                                                           9
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                           Project Launch
                                                                          31 January 2012

     1.    Product Innovation – new mode of transport
     2.    Process innovation –new way of being mobile
     3.    Position innovation –new form of mobility
     4.    Paradigm innovation

    The next was the Best New Mobility Social Enterprise Award. In searching for
a new business model, the project team decided to focus on social enterprise
specifically for the transport sector that address new mobility problems especially
that of the poor and vulnerable. Entries must reflect sound management, should be
properly documented and reflect a social enterprise (SE) that meets multiple bottom
lines. SE uniquely uses the capabilities of different stakeholders as leverage to
deliver goods and services in the area of mobility to meet multiple bottom lines. It
can target the following or even more bottom lines:

           Surplus or profit generation, where profit is reinvested for the gain of the
            stakeholders and further pursuing the social objective
           Environmental health
           Preservation of cultural integrity and diversity
           Capacity development or empowerment of a sector or community
            simultaneously improving their quality of life.
           Climate change

   Below were examples of probable entries around the globe Ms. Dator-Bercilla
presented:

           Cargo bike of Worldbike
           Mini-Bus Operation, Day Care Transport, Special Education Needs
            Transport by the HCT Group in UK.
           Agency Community transport Model and Transport Asset Management
            Riders for health
           Non-emergency Medical transport by Tranmedic
           Mobility Scooter by Rugged Tree

    She also mentioned that the entries should be existing projects meeting the
following common criteria:

           Clear identification of mobility issues being addressed especially with
            those of the urban poor and vulnerable groups;
           Employ approaches that incorporate principles of sustainability in
            transportation that address issues in ecology, social equity, health,
            finance and economy, air quality, noise, climate; and
           Clear identification of challenges being addressed and of success
            indicators

   Lastly, she presented the schedule. After the project is launched, formal calls for
nomination would be open at mid February and run through March 2012. A
Committee deliberation follows around April-May 2012 and the winners can be
nominated to present at the Rio Entrepreneurship Summit in May –June 2012.
Before she left, she directed questions to Dr. Guillen.

                                                                                      10
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                                 Project Launch
                                                                                31 January 2012

VII.       Sharing the New Mobility Agenda

       A. Search for New Mobility Opportunities in the AdMU
          Fr. Jose Ramon Villarin, S.J., President, Ateneo de Manila University

                                            When the forum resumed after launch, Ms.
                                        Rogel introduced Fr. Villarin to share his thoughts
                                        on the new mobility opportunities in AdMU. He
                                        happily recalled the time when he used to walk
                                        from Dela Strada Church, 2 km away, to Ateneo in
                                        high school. The school did not have too many
                                        buildings then in 1970s and walking is something
                                        that the people like doing. But now as the school
                                        President for 18,000 students, the Challenge is
                                        making Ateneo a sustainably mobile campus. He
                                        shared that there are plans for pedestrianizing the
                                        campus. Currently, there are around 2,000 cars that
                                        park inside the campus and occupy 7.5 hectares of
       prime real estate and cost several billion pesos. What he sees and hopes for the
       campus is for it to become a carless campus.

           He looks forward to the New Mobility project because aside from helping others
       and the city, which he grew up in and learned to love, the project will also help the
       campus. He also hopes that the innovative ideas would not simply be shelved and be
       replicated and adopted by other campuses in the country. He shared that majority of
       the ideas will depend on how lands are allocated.

           Before he left, he welcomed everyone to the campus and wished for the project
       to succeed. He also emphasized that AdMU, contrary to what is perceived by many,
       is not an elitist school. He proudly claimed that they form their students to look
       beyond the campus and include the marginalized people.

       B. New Mobility Initiatives of the MMDA
          Hon. Francis Tolentino, Chair, MMDA

                                        Chairman Tolentino started with a photo from the
                                    Balikatan exercise, a general being carried on the back of
                                    another man. He said that this photo illustrates the
                                    situation of transport mobility in our country where
                                    people are indolent walkers. More than the concept of
                                    pedestrianization, he deemed it necessary to find out
                                    why there is a need to motorize. He expressed his
                                    thought that this project should also look into why
                                    Filipinos are not pedestrian citizens.

                                     He then moved to presenting the new mobility
                                initiatives of the MMDA. He announced a proposed
                                skybridge project that would utilize esteros to address
                                hopefully address mobility issues. He hopes that this
       would open the minds of urban planners, policy makers, local legislators and city

                                                                                            11
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                        Project Launch
                                                                       31 January 2012

engineers that it is about time they utilize esteros for transport purposes. He
proposed a shift in outlook for esteros as source of crimes, disease, flood, urban
decay etc. He stressed the importance of esteros to renew Metro Manila similar to
Seoul, Korea; Bangkok, Thailand and Macau. He said that they intended to publicize
the Skybridge project in the next weeks. For the New Mobility initiative, he agreed
that everyone must free himself or herself from the tendency to see Metro Manila as
roads and bridges and see that it is made of human beings. He found it very
appropriate to include the poor and marginalized sectors in the project.

    He then moved to presenting the following future and current projects of MMDA
(See Annex H):

   1. Plan to have bicycle lanes from Remedios Circle to Intramuros

   2. Construction of pedestrian-friendly footbridges: These footbridges aim to
      avoid conflict between motor vehicles and pedestrians by providing safe
      movement at intersections in selected locations. Instead of using the usual
      road or pedestrian lane, the MMDA created footbridges as an alternative and
      safer way to go to the other side of the road. The MMDA will be taking the
      design and construction of footbridges in a whole new level. The new design
      to be constructed in Sucat and funded by the DPWH, will include man-lifts,
      which can accommodate up to six persons in any given time. With this
      design, persons with disabilities (PWD) will be able to traverse the other
      side of the road safely and more conveniently.

   3. Elevated loading and unloading bus bays: The bays aim to eliminate the
      practice of indiscriminate embarking and disembarking of bus passengers in
      non-designated areas. The agency is proposing to implement the elevated
      loading and unloading bays, similar to what is being implemented in Jakarta,
      Indonesia. Bus bay will have an elevated platform approximately one meter
      from the carriageways. Likewise, bus floors will be customized to align with
      the boarding platform. Bus bays will be modified to ensure the convenience
      and safety of passengers by providing roofs, seats and proper ventilation,
      among others. Ramps will also be provided for the elderly and the PWDs.
      There is now a Land Transportation Franchising and Regulatory Board
      (LTFRB) resolution signed regarding this so Chairman Tolentino was certain
      that this would be implemented. Hand in hand with this initiative is MMDA’s
      push for bus drivers to receive fixed salaries to prevent them from hoarding
      passengers. A single ticketing system of traffic violations across Metro
      Manila which aims for a centralized database of traffic violations is also
      expected to run by March.

   4. Motorcycle lanes: For Chairman Tolentino, this is the best indication that
      Filipino drivers can be disciplined. Motorcycles have steadily proliferated in
      the metropolis and they contribute to traffic congestion. Given the limited
      training of motorcycle drivers at the onset, they can endanger road users’
      safety. In response, MMDA designated non-exclusive motorcycle lanes or
      “blue lanes” along Commonwealth Avenue in Quezon City (QC) and
      Macapagal Avenue in Pasay City. This will be expanded to include EDSA
      starting February 14, 2012. Since its implementation in Commonwealth and
      Macapagal Avenue, there was a significant reduction of accidents in the
      mentioned thoroughfares. Chairman Tolentino hopes that this will pave way

                                                                                   12
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                      Project Launch
                                                                     31 January 2012

   for bicycle lanes, and that with the right infrastructure, support and mindset,
   this can be accomplished.

5. LED Message Board: MMDA will be installing light emitting diodes message
   boards in major roads in Metro Manila to provide traffic advisories as well as
   road safety reminders to guide road users. An example of this is the led
   message advisory along EDSA Main Avenue, Southbound.

6. Mega Manila Provincial Integrated Bus Axis System: MMDA is embarking on
   The Mega Manila Provincial Integrated Bus Axis System (MM-PIBAS) which
   aims to improve traffic conditions by prohibiting provincial buses from
   plying the major thoroughfares of Metro Manila, minimizing public bus
   transport congestion, eliminating vehicle-pedestrian conflict and promoting
   faster mobility. This will be done by providing central terminals in the north,
   east, south and southeast for provincial buses coming from those corridors.
   The MM-PIBAS shall be patterned from existing centralized bus terminals in
   other countries. Looking at airports as models, the MM-PIBAS is envisioned
   to be a terminal building complex with large area to accommodate many
   buses, park and ride facilities, dedicated space, which allows the mobility of
   passengers and convenience of cargoes and suitable location accessible to
   other modes of transportation. The idea is to consolidate the 85 existing
   provincial bus terminals with 60 bus companies operating approximately
   7,368 buses into 4 common terminals (North, East, South and South East).
   Chair Tolentino announced that President Aquino will be releasing an
   Executive Order in February directing MMDA and DOTC to start working on
   this. Hence, Chairman Tolentino’s quick trip to Seoul the following day with
   DOTC officials to specifically look at the operation of their bus terminals. He
   strongly believed that this would be President Aquino’s pet project so it is
   likely that this would be operational at the end of the year.

7. Vehicle Tagging: MMDA’s vehicle tagging scheme involves the permanent
   painting of license plate details of public utility vehicles (PUVS) on all sides
   of the vehicle and roof. Each type of PUV has a distinct colored background
   with prescribed measurements for the text and background. This was
   partially implemented on city buses starting last August 15 and on AUVs on
   December 12 last year. The scheme has helped in tracking and apprehending
   vehicles that have committed traffic offenses and city buses operating
   outside of their franchised routes. It has also diminished the unlawful
   practice of bus operators swapping plate numbers and the number of hit-
   and-run incidents committed by reckless bus drivers. This initiative came
   from the transport sector. This is part of the government’s public private
   partnership and has no cost to the government.

8. Metro Manila Traffic Navigator: A major public-private partnership initiative
   of MMDA in coordination with TV 5. An online media service providing
   updated traffic situations in 9 major thoroughfares, EDSA included. Using
   this system, passengers and motorists are being empowered to make well-
   informed decisions taking alternative/less-congested routes. This service
   can be accessed by any web browser-enabled device at
   http://mmdatraffic.interaksyon.com and may be downloaded to smartphones
   and tablets for free. The TV 5-MMDA traffic navigator was awarded the
   bronze Boomerang award for innovation by the Internet and Mobile
   Marketing Association of the Philippines (IMMAP) last August 18, 2011 and

                                                                                 13
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                         Project Launch
                                                                        31 January 2012

       the I.T. award of the year. This award symbolizes the power of combining
       technology and public service to bring real positive change. Chairman
       Tolentino wanted to ask the developers to make the program more visual
       and include intersections at real time.

   9. EDSA makeover project: MMDA is partnering with the private sector in
      transforming EDSA into a traffic discipline zone, making it a motorist/
      commuter and pedestrian–friendly thoroughfare. Other components of this
      activity are landscaping and greening, beautification, installation of adequate
      lighting along EDSA using energy efficient light emitting diodes (LED)
      technology especially on sidewalks, tunnels and footbridges to avoid
      proliferation of bad elements and installation of CCTVs, upgrading of street
      signs and maintenance of foot bridges. MMDA is looking at Mongkok and
      Suanlum in Bangkok as models.

   10. Estero Bridge Part II: This is an activity that aims to clean two esteros at a
       day. MMDA said this is challenging not because of the amount of trash but
       because of the people who want to be relocated. These people do not want to
       live in the estero de Concordia example. MMDA’s difficulty was how to
       transfer the people when government resources are limited. Chairman
       Tolentino called for everyone to change the way they look at cities as not just
       buildings but with people. Also change their perspective on esteros as areas
       of opportunities and harness the talents of the people living there. In the
       same manner, he called for people to look at transport in Metro Manila.

      At the end, he said he is looking forward to the results of the studies
   commissioned by the project to improve Metro Manila transport not just this
   year but in the years to come.

C. Responding to New Mobility Challenges of Quezon City
   Retired Brig. Gen. Elmo San Diego, Head, Department of Public Order and Safety
   Quezon City

    General San Diego reported that Quezon
City is one of the biggest cities that occupies
1/4th of Metro Manila. It has a population of 3
million with half belonging to the poor. QC is
also one of the richest cities throughout the
country and the richest in Metro Manila based
on the latest COA report. With such
characteristics, it attracts business investors
and also informal settlements. The biggest
challenge for the city is the increasing number
of informal vendors and how to eliminate them.
QC’s response to mobility challenges is how to
coordinate with other agencies to support their
programs.

    General San Diego also shared project Open Katipunan (OK) that they planned to
implement with Ateneo. The Ateneo community consists of grade school and high
school parents, students and student council members who meet every month to
discuss traffic and other problems along Katipunan. Ultimately, the goal of project
OK is to reduce cars traversing along Katipunan by 50%

                                                                                    14
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                         Project Launch
                                                                        31 January 2012

    Then he moved on to share their latest mobility program, the electric tricycles.
(See Annex I) To set the context, he said that tricycles are the most preferred and
most convenient motor vehicle used by the marginalized sector in QC. At the onset,
e-trike was a traffic initiative that reduces carbon emission within the campus but
the students wanted it to ply along Katipunan. The City Council deemed it dangerous
but they supported the idea nonetheless. In partnership with the Department of
Energy (DOE), QC was chosen as a pilot area to run e-trikes under the generous
funding of Asian Development Bank (ADB). The bank allotted US$ 40 Million for
32,000 e-tricycle units. It is a rent-to-own nationwide program designed jointly by
LGUs, DOE, ADB and government financing. The basic requirement is to trade
conventional tricycle with e-trikes.

    General San Diego showed photo samples of e-trikes that are actually used in
different parts of the Philippines like Palawan and Mandaluyong. He mentioned that
the initial design of the e-trike in QC failed because the units were underpowered
and could not handle the slopes of Payatas. QC was chosen as a pilot area because
they have the most number of registered tricycles with 5,000 plying as “colorum”. In
this regard, QC issued a moratorium in tricycle registration because of the number of
unregistered units plying the road.

    There were several changes proposed for QC’s e-trike program. This includes the
following:
     1) The use of Lithium-ion battery rather than lead. Lithium-ion is lightweight;
        its lifetime is more than 5 years, and saves space inside the unit.
     2) The construction of several charging stations all over QC.
     3) The use of a more powerful engine that can run the slopes of Payatas.
     4) The use of a fiberglass body to endure harsh weather conditions.

   He also presented advantages in using e-trikes which include the following:
    1) Fuel savings of about P200 from the regular income of drivers and estimated
      US$ 185 million per year.
    2) Aboost in the manufacturing industry since all parts are made locally.
      Manufacturers intended to participate in the bidding of ADB.
    3) An advocacy for cleaner air by avoiding carbon emissions that amounts to
      400,000 tons per year.
    4) Helping in the development of cities outside Metro Manila by donating
      retrofitted conventional tricycle units that would be traded in for e-trikes.
    5) A bigger potential income for drivers since they save on buying fuel.

    Also part of the proposal made with DOE and ADB is the gradual phase out of
petrol-fed tricycles. This would entail provision of incentives such as preferential
franchise or route for e-trike users and/or exemption from number coding scheme.
The city government is also gearing up for e-trike related business.

   The project hopes to complete e-trike units delivered to LGUs with a standard 3-
year warrantee. For QC, they will start distributing 2,000 units this year and 5,000
every year until 2016 for a total of 22,000 e-trike units. By 2016, ADB expects to
complete the distribution and operation of 100,000 e-trikes throughout Metro
Manila, QC included. Several provinces in the north like Cabanatuan, Palawan, Davao,
and Mindanao are also beneficiaries of the ADB program.

                                                                                    15
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                             Project Launch
                                                                            31 January 2012

       The program is running in Mandaluyong already. General San Diego showed data
   on the management and operation of their e-trikes and the result was quite
   encouraging. He showed a simple comparison between a standard trike and e-trike
   in terms of fuel savings, economic savings etc. E-trike costs more than a standard
   tricycle (P200,000) because of its battery but when it comes to road space, 2
   conventional trikes = 1 e-trike. E-trike also carries 6-8 people while conventional
   carries only 3-4. Gross income of drivers on a daily basis amounts to P800 for a
   conventional tricycle and P1,600 for an e-trike.

   D. SMART Program and New Mobility Initiatives of the University of Michigan
   Ms. Susan Zielenski, Managing Director, SMART Center University of Michigan

                                  Ms. Zielinski informed the audience that the New
                              Mobility project of iBoP Asia is a sister study in SMART
                              Centre also which also got itssupport from the Rockefeller
                              Foundation. They share the same sister community in
                              catalyzing new mobility in cities. She explained that the
                              following day, participants would experience SMART
                              mapping.

                               The three things the new mobility project aspires are:
                                  Connecting the dots: For livability, sustainability,
                            equity
                                  Moving money: Innovation, access, jobs,
                            enterprises
 Moving minds: New way of looking at transport and cities.

       She presented existing labs in the different parts of the world and their partners
   and sponsors. (See Annex J) She posed a question: “Why did the chicken cross the
   road?” and got diverse answers from the audience. But she said chickens do cross
   the road for the sake of moving. They do it in order to go to the other side of the road.
   She encouraged everyone to think of accessibility (meeting needs) rather than
   mobility as the goal to open up a range of new options for innovation, including IT.
   For example, making trips shorter and more efficient through IT enhanced
   integrated mobility, but also through eliminating trips through IT enhanced land use
   and urban design, and even more immediate, replacing trips altogether with IT such
   as tele-work, tele-shopping, tele-banking, tele-education etc. Mobility is not only
   about moving people. Mobility is transportation capacity expansion, land use
   planning and travel demand management. We all live in a world where
   transportation is equated to cars hence, improving transportation means improving
   cars. She noted that people are culturally connected to their cars that everything else
   becomes extraneous. She presented words that describe this connection: “captive”
   and “transportation disadvantaged” where captive means having no choice while
   transportation disadvantaged is when anyone who has no access to a car becomes
   poor and because he/ she has to ride a bus. In this association, people assume that
   transportation is necessary. Therefore, cars are necessary; therefore to improve on
   transportation, we improve on cars and that is why car companies make car
   improvements a lot. She asserted that life would be much better if we have more
   choices and not just simply choose to have a car.

     She also dissected the words typically associated with transportation and
   mobility, which she felt, must be changed to something more exciting and true:

                                                                                        16
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                           Project Launch
                                                                          31 January 2012

            Captive – means forced
            Transportation Disadvantaged
            Alternative Modes– seems like the “alternative” will never make it.
             Sounds like second choice.
            Public transport cost versus investment
            Transportation demand management – sounds constraining and
             associated with sacrifice
            Sidewalks - sounds not too prioritized as the they refer to the side of
             something
            Road closing versus openings
            Car use reduction versus more options

       She wanted everyone to transform the notion that transportation is flat. There
  are actually more connected choices in new mobility. This transformation of
  paradigm from monolithic to multi-faceted and connected is a foundation for a
  major emerging industry. The new paradigm she proposed was based on the tons of
  innovation going on around the world. Mobility is about moving people, moving
  goods and moving less. This is highly evident in the greater desire of young people
  these days with IT than cars thus, IT is not just about moving people but also about
  moving goods and moving less. She advised that when implementation seems
  difficult as to which should be done first, she told the audience to do it all at the
  same time. Then she commended the event because it gets people together.

      She emphasized the importance of connectivity and optimization of all kinds,
  which can be seen by mapping. In mapping, a new mobility grid can be revealed by
  identifying and overlaying everything. Implementation is like a human body system,
  a system that needs all parts, big and small to run. One would never ask which is
  better or force the choice between the heart, lungs and pituitary gland because they
  are all necessary. It goes the same for transportation. Focus must be given more on
  increasing, optimizing and enhancing the connectivity of the current options. In new
  mobility, there is huge economic activity, saving money, creating jobs, and
  revitalizing local economy.

      She ended with a hope that a lot of entries will come from the Philippines in the
  SMART Mobility enterPrize. This is an award for entrepreneurial ventures in
  sustainable transportation created by University of Michigan’s SMART initiative and
  with support from the Rockefeller Foundation. The entries should demonstrate
  innovative and replicable solutions to local and global transportation challenges, up
  and running, legal and can come from anywhere from the world.

VIII. Open Forum

      After lunch, Ms. Rogel opened the floor to questions, comments and suggestions.
  The participants were requested to approach the microphones in the aisle, state
  their name and organization before speaking.

         QUESTIONS/ COMMENTS                         ANSWERS/ RESPONSES
   Concerns from Elvira Medina, President
   of National Center for Commuter Safety
   and Protection:

   a) On the use of e-tricycle. Electricity is 1) Engr. June Yasol, General Manager

                                                                                      17
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                         Project Launch
                                                                        31 January 2012

        QUESTIONS/ COMMENTS                ANSWERS/ RESPONSES
still generated from fossil fuel and what
                                    of JAYAREC: The units are not
about the horrendous electronic waste
                                    powered by lead acid but Lithium ion
generated in using lead acid to operate
                                    battery. It has 3-year warranty and 5
the units? For her these should be  years life cycle with performance
addressed.                          tested to last 10 years. Indirect use of
                                    fossil fuel through charging as
Mr. Bharat Bongu(Intellicap):       compared to use of gasoline. Drivers
                                    could also earn more by saving money
What are the costs 5-years down the on gasoline.
line for e-trikes?
                                    2) Benjie dela Peña: Personally not in
                                    favor of solutions that only look at
                                    technology but transport mobility
                                    needs all the help it can get. One thing
                                    that e-vehicles can do is it moves up
                                    the question of source of fuel higher
                                    up the chain. If you move it up higher
                                    the chain, it is easier to change the
                                    system. It does not matter with the
                                    driver the source of fuel as long as it
                                    gets its electricity. It is easier at the
                                    platform to change the source of
                                    power.

b) Ms. Medina also commented on the          Benjie dela Peña: The issues of the
framing of the poor and vulnerable. The      poor and vulnerable are not only
use of the term poor and vulnerable          about transportation. The expression
versus use of general public. “Poor” is      of what is poverty also changes from
an     economic      condition       while   situation to situation. In the US there is
“vulnerability” is a physical and social     an infrastructure gap, people who live
condition. The poor and vulnerable           near mass transit lines can afford to
should not be separated from the             use cars and go to offices using their
general public but be coiled into one        car whereas poor have no access to
term: “commuters”. In the BoP, the           public transport stations thus they
biggest sector is commuters. Many of         need to buy cars but have no means to
the poor are economically active but         do so. The terms “poor” and
have limited opportunities and they use      “vulnerable” works well for the
public transport. Quality of life revolves   Rockefeller foundation. It caters to
around the term “commuter”.                  particular interest of the issues of
                                             people who do not have adequate
                                             housing      and     opportunities     in
                                             livelihood.

Bert Fabian, CAI-Asia:

Fully supports the forum but needs
continuing discussion. There is great
opportunity in the fact that President
Aquino, MMDA Chairman Tolentino and
AdMU President Fr. Villarin are former
classmates to have these discussions. It
looks like there is still an inconsistency

                                                                                      18
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                        Project Launch
                                                                       31 January 2012

        QUESTIONS/ COMMENTS                        ANSWERS/ RESPONSES
in the concept of mobility especially
since most of the major projects are
still centered on vehicles and not on
people. Government can or must
campaign for better public transport
that is on time and convenient. But
overall, he believes that it is high time
to have this kind of discussion on new
mobility so he emphasized that this
organization CAI Asia commits to the
project.

Engr. June Yasol, General Manager of
JAYAREC:

When talking about catalyzing new           Dr. Segundo Romero: In catalyzing
mobility in cities, are you referring       new mobility in cities the key word is
more on RnD or is there application for     mind shift. How do you break the
grants (e.g. invest on e-trike pilot        paradigm of the poor to somehow
projects). There is a need to have solid    accept the imposition of car owners to
ground for mobility and not just ideas      be on the same boat? The project does
                                            not aspire to give commuters a better
                                            transportation system but the project
                                            offers them up to the possibility of
                                            what can be done. Start with very
                                            small things like having a pool of
                                            knowledge and come up with a map
                                            on informal transport hubs to be
                                            shared to everyone. The project is
                                            trying to motivate the target
                                            beneficiaries to help themselves. Other
                                            countries already have maps available
                                            and if we do not start soon, our
                                            country might be left with bad handed
                                            down technology by our neighbors. It
                                            is a contest with them also in
                                            improving our transportation mobility
                                            faster than they do. In this regard, the
                                            New Mobility forum is targeted to
                                            happen every month with different
                                            stakeholders.
Dr. Kardi Teknomo from Ateneo:

One of the most important mode of           Dr. Segundo Romero: This is where hi–
transportation is walking especially for    touch mapping effort might help.
the poor. Unfortunately, most of the        People looking at maps and identify
innovations were more on vehicles           sidewalks, blockages etc. opportunity,
such as e-trike or e-jeep. Walking needs    facilities that work and those that do
no facilities but needs monitoring. The     not. Once identified, what can be
system of monitoring does not happen.       done? Is there something for the
Reporting and feedback from the             barangay captain to do? What about

                                                                                   19
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                         Project Launch
                                                                        31 January 2012

    QUESTIONS/ COMMENTS                             ANSWERS/ RESPONSES
community is needed.                         the Head of the association? It
                                             becomes       actionable       because
                                             information     becomes       tangible.
                                             Bringing the action down to the
                                             barangay might yield quicker and
                                             better result than relying on
                                             government alone to take action. The
                                             proper mind shift is that it is not
                                             always the government or MMDA’s
                                             role. If the community can do
                                             something, they must act on it.
                                             Advocate for social accountability.

Mr. Alberto Suansing, Executive Director
of Philippine Global Road Safety
Partnership - Philippines:

Hope springs eternal. He mentioned           Dr. Danielle Guillen: This project is not
that various studies and talks about         only RnD, it is about complementing
transport and mobility exist but he was      and reaching out. She told the story
glad to have this forum to raise             about TODAs not knowing where the
problems and come up with solutions.         other terminals are as a clear example
These transportation mobility issues         of the need to complement public
had been talked about but problems           transport service. The project aims to
arise due to neglect. The Government         introduce the idea of complementing
was not really able to focus on public       each other work to be efficient and
transportation. He shared about              have the connection. The project also
dispatching nightmare in buses and his       emphasized on IT and the promotion
thoughts on how improving the salaries       of transportation planning. It is a top-
of bus drivers may not fly because the       down and bottom-up initiative where
current system is still weak. The            talking with policy makers happens at
operators in our country still focus on      the same time as rounding up new
their business and not public service.       business models and innovative
He believes that fare increase to cope       solutions at the community level
with fuel increase is not the answer to
transport problems rather optimizing
the use of roads. He also said that there
is politics in terminals. Then he raised
the issue on safety of commuters.
Nevertheless, he was glad that mobility
is now being looked into. There are so
many solutions that can be applied. The
good thing is that this project has social
aspect. He expressed his skepticism on
MMDA’s UVVRP, which will not work in
the long run because it only increases
the volume of vehicles. Most people buy
another car just to avoid the UVVRP.
The country has been compared to
Singapore a lot but Singapore
compared to the Philippines has a very
respectable public transport system.

                                                                                     20
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                              Project Launch
                                                                             31 January 2012

            QUESTIONS/ COMMENTS                         ANSWERS/ RESPONSES

      Karmi Palafox from Philippine Institute
      of Environmental Planner and Palafox
      Associates:
                                             Susan Zielinski: Traffic congestion and
      a) The drawback in some of the         mobility are not different problems.
         mobility designs came from the      The question is how do you send the
         way urban planners conceptualize    right    signal?    What     are     we
         them. They think as if all are car  communicating about? It is more
         users                               important or necessary to know what
                                             kind of city we want to live in rather
      b) Is there congestion charging in the than think of congestion etc. What
         project?                            kind of transportation combination?

      c) Framing of poor and vulnerable. If
         progress is desired, involve the
         private sector. However, are they
         willing to do things for the poor and
         vulnerable? She suggested not
         using words that may turn off the
         private sector in marketing.

      Dr. Hussein Lidasan, Transportation
      Science Society of the Philippines:

      Supports this activity and committed to
      help in any way they can. The ultimate
      goal is to minimize the movement of
      vehicles but not the movement of
      people. But it is not just about mobility
      per se but also access. Economic
      measure is the dream of every
      transport planner. Economic measure
      means, people who are willing to pay
      will pay higher but they will be
      expecting an efficient transport system.
      In terms of information, people
      appreciated and understand better
      visual explanations rather than
      numerical. The bottom line is to see
      what is doable. Look at how you can
      connect the people through the
      transport system. This forum was a
      start and hoped to continue and
      improve or alleviate the cancers of
      transportation. He wanted to hear how
      to improve quality of life without
      compromising the environment.

IX.    Updates/ Insights from the Rockefeller Foundation

                                                                                         21
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                           Project Launch
                                                                          31 January 2012

   Mr. Benjamin dela Peña, Associate Director, Urban Development
   The Rockefeller Foundation

                                    Mr. dela Peña recounted his story or experience in
                                walking and commuting in QC before. For him, he
                                agrees to what Danielle said earlier, Metro Manila is
                                transportation rich especially in the poor areas.
                                However, there is a windshield bias by the policy
                                makers and decision makers and people always see
                                traffic as the main problem.

                                    His presentation centered on the seven needs of
                                transportation (See Annex K):

                                   1. Takes us where we want to go
                                   2. It takes us when we want to go
                                   3. It is a good use of our time
                                   4. It is a good use of our money
5. It respects us with the level of safety, comfort, and amenity it provides
6. We can trust it
7. It gives us freedom to change our plans

   Sometimes a shift in paradigm involves a change in jargon like calling the Traffic
Management Unit of MMDA to Transportation Management Unit. He emphasized
connections as very important in transportation and the poor and vulnerable as the
most affected. People who think about mass transit always think about speed. The
experience in mass transit is speed is not as important as frequency.

     Emphasis was also given to transportation sharing or allowing people to walk.
Some say Filipinos are lazy walkers but they do not realize that it is because facilities
are not available for people to walk on. When it comes to transportation, cars are
still the priority when it should be the people. A clear illustration are the steel
barriers in EDSA preventing people from hitting cars, denying people to move in the
way of cars.

    The good news is that the complications do not just happen in the Philippines.
Other countries experience drawbacks so as they find solutions, the country can
learn and we can share the experience.

    He said that there is hope starting with conversations. It is not fair to put it all in
the hands of the government and believe that they will solve the problem. The
government has to deal with electoral issue (the official’s terms) and budget cycle.
However, the government should also have a clear vision and not just presenting
solutions to problems.

    He ended with a quote by Jan Gehi from Making Cities for People:

    “To be a lively, attractive, safe and sustainable city, (a city) must be
    sweet to its pedestrians, sweet to its cyclists.”

    There is a movement of a shared longing.

                                                                                       22
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                           Project Launch
                                                                          31 January 2012

X. Understanding the Challenges and Opportunities in New Mobility

   A. How responsive is Metro Manila’s Public Transport System to the Needs of
      the Poor and Vulnerable Sectors? Insights from a Mobility Mapping Case
      Study of Metro Manila
      Dr. Jun Castro

                                       This is one of the three commissioned studies
                                   of iBoP about mapping. It tackles the question,
                                   how mapping can be used to respond to the needs
                                   of the poor and vulnerable. The study uses
                                   Geographic Information System (GIS) as tool
                                   similar to google earth. GIS has been used in a
                                   number of planning studies to organize large
                                   volume of information. There are limited studies in
                                   linking mapping, public transport and the poor/
                                   vulnerable.

                                       The following are the research project goals
                                   (See Annex L):

       Use of GIS, identify, map and assess PT supply (modes, routes and facilities)
       Identify gaps in the data sets or barriers to access these data sets
       Assess the mobility of the urban poor and vulnerable sector in relation to
        transport supply
       Identify transport-related improvements in infra and services that will
        benefit urban poor communities in the case study areas

     This research will run until March 2012. It will use primary data collection,
 identify alternative mapping techniques, develop a database of public transport
 hubs and map out public transport networks. The expected output is a
 documentation of process for generating, encoding, storing, sharing and displaying
 user-friendly maps of public transport hubs/ terminals using a GIS database.

     The methodological framework starts with a review of data followed by
 database development where the team will be asking existing private database, use
 crowd-sourcing, field surveys and validation. Next is to do spatial analysis using GIS
 overlaying transportation and its relationship with informal settlements will come
 after. Last step will be publishing the result.

      In their initial review of data, they looked at some of the database of MMDA such
 as studies on informal settlements, which involve a map of informal settlers in Metro
 Manila. As part of the database development, the team will use the SMART mapping
 technique, validation and photo documentation. The team started its field survey
 with the informal pedicab terminal in Agham Road. They tried taking photo
 documentation of the area but a man blocked their camera. Once data is available,
 they will transfer it to an open source map like google earth to visualize the location
 of the terminals. After which, it will be converted to GIS format. The gist of the study
 is the spatial analysis to see how the data sets relate together. Proximity analysis or
 buffering will be used that involves creation of areas around a geographical entity
 based on measurement of distance.

                                                                                      23
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                          Project Launch
                                                                         31 January 2012

    The goal of the research is to come up with a transit map, including pedestrian
walkways. Study areas identified were North Edsa - Agham Road, Matandang Balara,
and in Payatas where urban poor communities are concentrated. He also presented
some preliminary results both in numerical and visual form where he showed
partial mapping of the public terminals in North EDSA. Network analysis will be
done once the network of terminals is in place. Mapping could be used as a tool to
identify improvements in public transport system. He emphasized the importance of
converting the result to GIS format and the conduct spatial analysis and apply to
programs.

B. Case Studies on the Mobility Characteristics, Cost and Issues of the Poor and
   Vulnerable Groups
   Mr. Randolph Carreon

    The study aims to understand the mobility characteristics, costs and issues of
the poor and vulnerable. (See Annex M) Specifically it aims to:

      Establish the travel demand patterns of the poor and vulnerable groups;
                               Look qualitatively into the efficiency of the public
                              transport system vis-à-vis the needs of the poor and
                              the vulnerable groups;
                               Estimate the cost of mobility of the poor;
                               Estimate the actual and desired cost of transport of
                              those within the vulnerable groups; and
                               Examine other non–quantifiable costs, if any,
                              incurred by the vulnerable groups

                                      Mr. Carreon defined first the poor and vulnerable
                                 using income as basis. They defined them as those
                                 living within the colonies of informal settlers. The
selected study areas in QC were Purok Centro in Barangay Old Balara, Agham Road
and GK Village in Payatas. The first one (Purok Centro) was chosen because it is
along Katipunan and has been affected by the C-5 extension project. Second (Agham
Road) was chosen because of its proximity to transport terminals and GK Village in
Payatas because of the reforms made by GK present in the community. After doing
all three, there will be inter-area analysis. Vulnerable groups were defined to include
PWDs, senior citizens, women, children. The research woull also consider those
working in the business process outsourcing firms whose office hours are irregular.

    The team of Mr. Carreon started with data gathering using household interviews.
Public consultations were done to evaluate and validate the results of the interviews.
Individual interviews, key informant interviews and focus group discussions would
be conducted for the vulnerable groups. The primary data would also be supported
by secondary data collection. As project update, Mr. Carreon said that they are now
doing public consultation and that their data gathering would run from February to
March 2012.

    He also presented the photo documentation of their data gathering and general
findings in Purok Centro. The data showed that people primarily leave their house to
go to work and school. Of the estimated total of 20,000 trips per day, aside from
walking, the top 2 transport modes used are PUJ, and tricycle. Generally, the people
said they would walk if they could walk.

                                                                                     24
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                          Project Launch
                                                                         31 January 2012

    He presented numerical representation of average annual income and expenses
divided into those who are renting and those who are not. The data were further sub
divided into those with motor vehicles (MV), mostly 2 wheeled, and those without
vehicles. Notable result was that it was still a rational choice for the community to
invest on two-wheel MV. The perceived primary mobility problem the community
saw was high transport cost while the rest share the same percentage (travel time,
traffic congestion, availability of public transport vehicles, crowded public transport
vehicles). The proposed solutions, still from Purok Centro, were all economic related
such as work for additional income. Walking came out as their last resort.

C. A Preliminary Inventory and Typology of Enterprise Models for Inclusive
   Mobility in Metro Manila: Of, By, and For the Poor and Vulnerable
   Ms. Tieza Mica Santos

                                   As introduction, Ms. Santos compared the
                               transport mobility designs in our country similar as
                               those of fashion victims. In most cases we see flyovers
                               that somehow do not fit the actual needs of the
                               people. The country tends to copy transport systems
                               and designs of other countries not knowing that some
                               of the designs do not fit in the context of Philippine
                               mobility. She said that in adapting new mobility
                               designs, the country has to consider policy, logistics,
                               feasibility, economics and social aspects. (See Annex
                               N)

    Commissioned to look at existing transport/ mobility related social
entrepreneurship opportunities in the transport sector, they are also looking at
sustainable innovative ideas and business models on new mobility and transport-
related that have high potential for scale and replication, benefiting the poor and
vulnerable sector and looking at the market barriers and enablers in terms of policy,
economic and socio-cultural and lastly help in the creation of new platform, resource
center and enabler of innovation.

   The research focuses on commercial and enterprise component of the transport
and new mobility sector. Key variables would be barriers and enablers. In terms of
methodology, they combined qualitative and quantitative.

    Focusing on 3 areas mentioned by Mr. Carreon earlier, their output will also
include a template or a modeling featuring social entrepreneurship as a new
mobility solution. They are specifically tasked to come up with:

      Mobility challenges of the poor and vulnerable
      Existing mobility business models
      Emerging new mobility business models
      Social enterprise opportunities for the mobility transport sector

    She presented the research questions they will use. The primary considerations
for emerging new mobility sector she highlighted were:

      Efficient (time to get to point A to point B)
      Cost

                                                                                     25
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                          Project Launch
                                                                         31 January 2012

      Environmental
      Convenience and Safety
      Human-centered design principle

    Design thinking model will be used rather than the usual linear model design.
Design thinking calls for more holistic and dynamic disciplinary approach to
understand the problems. Instead of step by step process, it will look are how each
key variable correlate to each other. This will show how new business models will
emerge. Human-Centered Design (HCD) will help you hear the needs of
constituents in new ways, create innovative solutions to meet these needs, and
deliver solutions with sustainability in mind.

    Data gathering uses the qualitative method by secondary data analysis and RRL,
FGD, KII and community consultation. Quantitative method would also be used
through survey and area sampling.

   Social Entrepreneurship is defined as an activity, as an approach or methodology
and as a business model. Social enterprises are categorized by nature, social aims
and outcomes, and in terms of leadership and sectoral-base. The study team treats
innovation both as a process and as an outcome.

Barriers and enablers will look at:

      Policy – standards and regulatory mechanisms
      Economic – market model and supply-demand correlation
      Socio-cultural – important deals with human ecology, cultural, anthropology,
       patterns of behavior, social context

     She presented a summary of pretest data gathering and the recurring themes or
variables from the poor and vulnerable consisting of cost, length of travel, travel
time, and access to basic goods and services in terms of cost of the goods. The team
tried to capture the various products and services that can be attached to transport/
mobility. They also looked at how the community access information. Two recurring
platforms were raised in terms of ICT access: mobile and Internet. In terms of
affordability, these consumers are able to afford more information coming from
mobile technology and Internet. In terms of information services, they invest too
much on transport cost than service feature. In terms of willingness to pay, they are
willing to pay around P7. Majority have difficulty in availing healthcare services and
finding employment but the primary issue is not in terms of inaccessibility directly
but more in terms of actual cost of goods due to lack of employment. 77% attribute
their difficulty towards the cost of availing of these goods and services. In the
process of RRL, the recurring themes that came up were: 1) sustainable
transportation related to sustainable targets and sustainable legislation for
transportation and land coordination policies/ designs, inter and intra-agency
collaboration approach, agency prioritization and allocation process; 2) Energy
efficiency, probably because of increasing oil prices and environmental health
consideration. In addition are: multi modal mobility, multi-stakeholder approach,
human patterns of movement, predictability of movement of goods and people and
minimizing costs. In terms of barriers and enablers, they searched policy, economics
and socio-cultural in literature. The recurring challenge in terms of policy was most
of our regulatory frameworks are uncoordinated, fragmented, unsustainable and do
not offer support for the development of sustainable pro-poor mobility structures.
In terms of economics, current economic incentives are mostly private sector biased;

                                                                                     26
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                            Project Launch
                                                                           31 January 2012

  mobility models are designed not to cater to human needs but for profit. Lastly, in
  terms of socio-cultural, urban development and transport system designs in Metro
  Manila are out of sync with patterns of settlement, human ecology, consumer
  behaviors, and unsustainable land and resource planning.

      Lastly, she presented a graphic representation of their main point, how the
  mobility designs are not in sync with the way people move. . The main goal of this
  New Mobility SE search through a human-centered design process is to understand
  the minds of the people and how goods and services should be delivered sustainably
  to cater the needs of the vulnerable. The study wants to understand how policy
  makers, urban planners and transport specialists envision the way cities are built,
  how transport systems are developed, how we think and re-think the way we
  construct Metro Manila. Understand first what do we make out of our cities and why
  has Metro Manila evolved into what it is today before going to the drawing boards
  and conduct urban planning. She reminded everyone the need to look at what is
  viable and feasible in designing mobility infrastructures. Look also at what is
  desirable and what caters to the actual needs of the people. It is often seen that the
  transportation systems shape the way people build their cities, but tend to neglect
  that it is human patterns of behavior and cultural activities that are at the center of
  how urban development should be designed. As Metro Manila reaches to a point of
  exponential growth, human needs dramatically change simultaneously with it. She
  wanted all to ensure that things fit like a puzzle and that city and mobility
  infrastructures are built central to human progress. Otherwise the country will
  continue to become fashion victims.

XI. Open Forum

         QUESTIONS/ COMMENTS                           ANSWERS/ RESPONSES
  Benjie dela Peña: Acknowledged               Randolph Carreon: key is to provide a
  representatives from Intellecap              better public transport system
  (Manish Shankar and Bharat Bongu)
  who are also grantees of the
  Rockefeller Foundation.

  How do you solve people who say it is
  cheaper to buy 2-wheel MVs than
  commute or use public transport?
  Some considerations from Niña Zialcita
  of People Power Institute:

      a) Goal is to promote walking, goal
         of mobility really is to make
         cities more walkable in the
         sense that you are not
         endangering your lungs,
         breathing in toxic air etc.
      b) When mapping out transport
         hubs and terminals, please also
         consider flood zone areas.
         When we speak of the poor and
         vulnerable, everyone is
         vulnerable in flooding. It is safer

                                                                                       27
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                          Project Launch
                                                                         31 January 2012

      to ride a pedicab than ride
      vehicles during flood.
   c) Consider also senior citizens
      and PWDs in mapping out the
      hubs. What will be the
      convenient options for them?
   d) Examine the option of not
      moving at all and not just
      moving around. Conduct
      dialogues to encourage
      carpooling and telecoms. Give
      incentives for carpooling and
      encourage people to conduct
      business online more and
      discourage 3-hour long
      meetings. Look for alternative
      modes of working that donot
      involve moving and open up
      additional avenues to do things
      and give options than having to
      travel.
   e) Once the mapping is available
      online, please share it with us.
      There are available similar
      mapping activities but for
      different goals or collaboration.
Comments from Sheila Napalang from
UP-NCTS:

a) Agree on inclusive transport that are
accessible to everyone including
women and PWDs
b) Informed everyone that the National
Government has adopted an
Environmentally Sustainable Transport
Framework. She suggested looking at
this framework and discovering how to
mainstream this. There are many
policies available out there but making
it more digestible is important as well
as making it accessible to people who
will be using this.
c) Access to the maps. If maps are           1) Benjie dela Peña: Maps on the
available only in the internet, it may not   internet are in open data format
be very useful. Printed copies may be        meaning any machine can read the data
more practical to be posted on               and interpret. He gave the example of
barangay halls and are much acceptable       Kibera in Africa, created by citizens
to people. She provided an example on        using GPS data. The idea, similar to the
their study in Cebu where taxi drivers       open street map concept, was to take the
are willing to pay more to get info on       data and turn it into a platform that
traffic areas and where to get               people can build things on in a form that
passengers.                                  people use like text messaging.

                                                                                     28
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                               Project Launch
                                                                              31 January 2012

                                                 2) Dr. Segundo Romero: He aspires to
                                                 come up with large maps to be put up in
                                                 public places. But in order to do this,
                                                 there is a need to gather information
                                                 first and translate the information to a
                                                 form that can be easily understood by
                                                 the public. Next is to print them out in
                                                 different sections to be given to the
                                                 private sector and be placed in big ad
                                                 spaces like the ones found in SM Malls.
                                                 However, to be able to do this properly,
                                                 collection of data was deemed to be
                                                 most crucial.
       d) Poor and vulnerable framing
       problem because poor may not be
       vulnerable and vice versa. What they
       need is access to information to have
       choices. We make the decision based on
       the information available to us. Some
       know but sometimes they do not have a
       choice. Information is power
       e) What are necessary to be included in
       the map? There may be confusion in
       terms of name: barangay, sitio.
       Recommended to use big landmarks
       rather than street names.

XII.      SMART Mapping Uncharted Connection Points in Metro Manila: The
          Participatory Mapping Workshop Approach and Process
          Ms. Susan Zielinski, Managing Director, SMART Centre University of Michigan

       Ms. Zielinski directly pointed out the core of this mapping exercise, which is how
   to customize and select people to map on and people to map with. This exercise
   brings together people that provide better representation of citizens or the
   community and not just planners. This evolved in a 4-step program. It starts by
   bringing together the private sector, small entrepreneurs, NGOs, planners,
   government from a wider range (e.g. social services, innovation, IT, economic
   development, tourism, finance, marketing). They all need to come together and
   understand that the need for mapping is the first step. Mapping essentially to create
   a tool, which people can dissect. Usually people talk about what is not working but in
   mapping, people need to see it the other way by identifying what works great and
   positive and exciting. Instead of presenting negatives, present them as challenges
   that will be solved. During the exercise, participants must build on what is there,
   preload all the different modes of transportation, overlay everything (tricycles,
   airports, boats, PUJs etc.) and look at connections. Eventually the exercise will
   reveal a mobility grid. Next, participants must identify where they can pilot their
   ideas. It is just a matter of identifying what you want to accomplish. It hopefully aims
   to raise economic opportunities by identifying opportunities for economic
   development. She asked for a shift in mobility language to a more positive outlook.
   She also deemed it important to create a vision and multiple ideas in order for the

                                                                                          29
Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                                            Project Launch
                                                                           31 January 2012

    mapping exercise to work. This interactive exercise ultimately builds communities
    and when hooked up with GIS, it tells a story to policy makers.

XIII.   The Way Forward for the New Mobility Project: Building a New
        Mobility Constituency
        Dr. Segundo Joaquin Romero, Director, iBoP Asia Program

        Dr. Romero was keen to see stakeholders interested in getting this project
    forward. ASoG through iBoP Asia offers a series of forum by people can habitually
    discuss new mobility. The event we are having is a large forum. The Project will be
    conducting several medium, small and large fora over the next several months to
    pursue this discussion. He informed everyone of a mapping project using SMART
    mapping framework and on-line platform as well as coordinating work. He was
    certain that stakeholders are out there just waiting to be organized. He hoped to
    bring in more people than the usual and be able to use the convening power of the
    academe.

        The event ended at around 4:00 pm with everyone invited to attend the pilot
    New Mobility Mapping Workshop led by University of Michigan-SMART Centre the
    following day.

                                                                                       30
ANNEX A
  List of Participants
ANNEX B
  Eagle Eyes Articles
Annex B
____________________________________________________________________________________
New mobility1
Last week I began a new series of columns on the
transportation challenges of Metro Manila, proposing a
change of paradigm from understanding our current
problem to be one from traffic to a transportation, or better
still a mobility, perspective. When I sent that first column to
Fr. Jett Villarin SJ, president of the Ateneo de Manila, he
reminded me to also propose solutions to the problems I
exposed. That is exactly what I do in today’s column, written again with the research
collaboration of Christian Laluna and the Innovations for the Base of the Pyramid team
of the Ateneo School of Government which is implementing with the Metro Manila
Development Authority a Rockefeller Foundation-sponsored project on Manila’s
transportation challenges. In this column, I propose an overall vision for solving our
transportation challenges, a vision defined by a concept I introduced last week, that of
“new mobility.”

New mobility’s convenience and reliability is rooted in a simple phrase used by Susan
Zielinski of University of Michigan’s Sustainable Mobility and Accessibility Research and
Transformation: “More choices, more connected choices.” Breaking it down, Zielinski
describes new mobility as “open source, multi-modal, multi-service, IT-enhanced user
focused, socially equitable, aesthetic livable whole systems transportation.” It combines
innovative transportation and communication technology with smart urban planning,
human-friendly engineering and design, and an emphasis on social equity, so that the
poor, the handicapped, the young, and the old (and yes, the rich, too!) can get anywhere
in the metro for work and play, even without a motor vehicle of their own. The real
game changer, according to Zielinski, is what turns “public transport” into “urban
mobility”: modality and seamlessness. It’s connecting all the mobility options of the
metro—cars and bikes, buses and trains, modes and services and technologies, public
and private—into a smooth-flow network that anyone can use, so that there’s no place
in the city that you cannot get even without a single occupancy vehicle.

The technology of this future already exists today, thanks to the innovative drive of
cities similar to Metro Manila, plagued by their own mobility woes, but refusing to
surrender to them. Bus Rapid Transit, known also as Busways, for example, was
pioneered by the Brazilian city of Curitiba in 1974, but has seen wide adoption (Zelinski
describes it as “gone viral”). BRT uses full-time bus-exclusive lanes to practically turn
buses into trains: a continuous, flowing service much like the LRT/MRT, but without the
heavy construction and investment costs of city rail systems.

I have seen the effectiveness of a BRT system as I have used it in Jakarta where the
TransJakarta Busway is designed on the simple concept of building elevated platforms
(operating as bus stations) where passengers get on and off the buses. Other places
where BRT has successfully been introduced include Bogota (Colombia), Guangzhou
(China), Istanbul (Turkey), Sao Paolo (Brazil), Mexico City, Seoul (South Korea),
Adelaide (Australia), Los Angeles (California, USA), and Portland (Oregon, USA). The
Transmilenio BRT in Bogota carries more passengers than 95 percent of the metro
(subway or light rail) systems in the world and they built Phase 1, all 41 kilometers, in
just 8 months. In Metro Manila, the best roads to pilot a BRT system are C-5 (already in

1
http://www.manilastandardtoday.com/insideOpinion.htm?f=2011/november/8/tonylavina.isx&d=2011/n
ovember/8
Annex B
____________________________________________________________________________________
the plans of MMDA) and Commonwealth Avenue where BRT would be a much faster and
cheaper solution to the planned Light Rail Transit line for that roadway. Indeed, aworld-
class BRT service can be built faster with full roll-out counted in months, not years, for
just a third of the cost of fixed rail transit.

Another emerging urban transport technology or practice is “fractional use” where
people, instead of owning their own vehicle, can instead rent a personal-use vehicle for
any amount of time for the day. For example, Zipcar (www.zipcar.com) in the United
States offers standard fuel or hybrid-engine and electric cars for rent to service
members. It’s like time-sharing for cars. Thanks to economies of scale through fractional
use, members thus enjoy lower mobility costs than if they had to own and maintain their
own vehicle. France and a few countries in Western Europe are experimenting with
peer-to-peer car sharing, where anyone can share their car and get paid for the use. Yet
cars need not be the only product offered: fractional use has also been used with
bicycles (both human-powered and electric) or rickshaws, which are perfect for getting
around an area like the Makati or Ortigas Central Business Districts, without taking up
too much parking and road space. There are many very successful bike sharing systems
around the world, including Paris’ Velib; Washington D.C.’s Capitol Bikeshare; Mexico
City’s Ecobici and Montreal’s Bixi. Nearer to home, Guangzhou’s bikeshare is integrated
with its BRT and metro systems and you use the same fare card to pay for either. India is
contemplating a roll-out of bike-sharing services as part of massive national investment
in urban infrastructure.

These transportation systems should be smartly networked, and also take advantage of
new technologies or other infrastructure, to increase their convenience and ease of use
for the general public. Zipcar, for example, uses apps installed on iPhones as part of its
service. In China, you can also shop and pay for other services using the Yan Cheng
Tongvalue card. Here in the Philippines, SM movie houses are taking advantage of
cellphone-swiping to claim cinema seats, and a similar service was once offered on the
MRT. An entrepreneur can easily take advantage of Metro Manila’s telecommunications
and Internet infrastructure to enable a fractional ownership mobility service for use by
anyone from Ayala Alabang to Tondo.

Lets imagine what can happen with new mobility. Take anyone of my law students (I
teach in the University of the Philippines College of Law in Quezon City, Ateneo School of
Law in Makati, De La Salle College of Law in Manila) living in Alabang, who has her own
car but hates the traffic jams along C-5, Edsa or South Super Highway. Instead of driving
all the way to Quezon City, Makati or Manila, she could take the South Luzon
Expressway (SLEX) to a convenient multimodal transportation hub in SLEX that has
been constructed to network mobility options. She can park her car at a garage in this
hub (or use a web-enabled, real-time ridesharing program like www.goloco.comor
www.pickuppal.com), and take the C-5 BRT, EDSA MRT or TAFT LRT which connects to
other options for her ultimate destination. Of course, it would even be better, if at some
point, we are able to connect this hub through bicycle lanes that bring my student
directly from and to her home - and even better still, at the end of the BRT/MRT/LRT
lines, such bicycle options also exist.

This vision of the future for Metro Manila, enabled by new mobility, shows how good
policy and smart thinking that brings together public efforts, private-sector innovation
and social entrepreneurship can address our transportation crisis. The Ateneo School of
Government hopes to move this along in January 2012 when we convene a mapping
exercise with stakeholders and launch the new mobility program with MMDA. In
working together, we secure our mobility future and renew our city.
Annex B
____________________________________________________________________________________

Moving Metro Manila - Eagle Eyes by Tony La Viña

Date posted: 2012-02-01 14:59:48

With this column, I resume the series on the transportation challenges of Metro Manila. I
started the series last October written with the assistance of colleague Christian Laluna,
If readers recall, I emphasized in the first two columns of the series the importance to
re-frame what we are facing in our metropolis, moving away from a traffic paradigm to
seeing the challenge from one of transportation and mobility.

This is an opportune time to raise transportation issues once again given the positive
developments last week in the Metropolitan Manila Development Authority, led by
Chairman Francis Tolentino, which finally got all the local governments in the region to
agree to a unified traffic ticketing system.

Today also, in its Loyola Campus, the Ateneo School of Government is formally launching
the New Mobility SMART (Sustainable Mobility and Accessibility, Research, and
Transformation) Mapping Activity, an opportunity to invite Metro Manila to sit down
together and rethink how we get about our cities, between our homes and our
destinations, and begin the transformation of our megacity from its present gridlock to a
vision of mobility for all: Equitable, economical, environment-friendly, and efficient. It is
part of ASoG’s efforts to unlock the full potential of Metro Manila, of its infrastructure,
and of its people―especially the urban poor.

It is acknowledged that the poor depend on publicly available mobility options more
than the rich for employment, security, health, socialization, and leisure purposes. It is
how they get to work, school, other family and friends, and meet their own needs and
developmental goals. Without public transport, notes an Overseas Development
Institute report on the subject, the poor are cut off from economic opportunities, denied
social services like health and education, and even stripped of their voice in the public
arena, because they cannot freely gather to exchange ideas and assert their rights and
interest in the political sphere. Indeed, there is an overriding interest of the state to
improve mobility for its citizenry, because it can improve economic efficiency and
reduce poverty.

Not all transportation development initiatives help the poor, though. In fact, the poor
are often the first to suffer from transportation infrastructure development. Building
more roads alone doesn’t necessarily help the poor because it emphasizes a priority on
car ownership, which Metro Manila’s urban poor cannot, or can barely, afford. Moreover,
the right-of-way needed to construct these roads all too often run through urban poor
communities, displacing them from their homes, and often times without relocation to
an area of their convenience.

The poor do have alternative options for getting around the city other than private cars
or public transport. Bicycles have become an increasing sight on roads all in the Metro
mostly used by security guards and construction workers but there are no specific lanes
dedicated for them except in Marikina, a laudable foresight for the city. Bikers have to
share the same road space as vehicles, with detrimental safety effects. Worse yet, most
drivers act as though they feel entitled to the road, and consider bikers a nuisance to be
rid of―not a mobility-friendly attitude among those lucky enough to own their own
vehicle. In addition, those who are lucky enough to be in walking distance of their
Annex B
____________________________________________________________________________________
destinations usually do not have good pedestrian facilities.

Gender and age also play a role in patterns of mobility, and the corresponding mobility
price. Studies show that women are often household managers and caregivers for
children or the elderly, and their trips are more frequent and irregular than the 9-5,
work-to-home commute of the average breadwinner. This means that they have higher
mobility costs, measured either by bus/jeep fares or gasoline budgets. Children, the
elderly, and the handicapped often require assistance to use public transportation―the
steep steps and elevated doors of buses, for example, prevent the use of wheelchairs,
and make the use of crutches and walking sticks a difficult, even painful chore.
Overcrowding these buses during rush hour only adds to the undeserved burden of the
infirm and elderly.

Finally, as is in the nature of poverty, it is the poor who are the most vulnerable to
shocks and dislocations to the transport network. We see this every time heavy rains
drench Manila, or a transport strike erupts. Often running on a tight budget, when the
buses or jeeps become unavailable on a given route due to flood or strike, commuters
might not have enough money for pricier options such as point-to-point and route-FX
taxis, or to take alternate, operating routes. Also, increasing gas, toll, and commodity
prices often drive bus and jeep fares up, impinging further on limited wallets.

While we have discussed transportation and poverty as it affects the poor from the
demand side, we cannot ignore the supply side of the equation. The employees of bus
companies are nearly always of the same social and economic strata as their passengers,
while jeepney and tricycle drivers either own their vehicle or drive on behalf of the
owner, usually a relative. In either case, these people are also dependent on the
transport industry, but with an added twist: as the pressures of population, economy,
technology, and politics transform Metro Manila mobility, these drivers and operators
will see the basis of their income change as well. They may be resistant to the added
costs of new initiatives, like improvements to engines, or making their vehicles
handicapped-friendly, especially when they feel it will come out of their pockets. Fearing
a negative impact to their jobs or their incomes, they would form the basis of any inertia
against changes to the transport sector.

We must be therefore fair: any changes proposed for Metro Manila bus, jeepney, and
tricycle services should also benefit the drivers and operators who depend on this
industry for their income. It does not take rocket science to get this done. Later in these
series, I will make specific proposals about what could be done.

This is the challenge to policy-makers and other stakeholders of urban mobility: We
have to expand the options available for mobility, introduce new methods of getting
around the Metro, and make them safe, economical, and easy-to-use for the
marginalized: the poor, the old, women and children, and the handicapped. Even as we
do this, we have to ensure that those who work in the transport sector can find
dependable income and social security from their line of work. And it can only be done
when everyone, driver and commuter, policy-maker and citizen alike, can raise their
voice and join hands in the same arena.

This is what Ateneo School of Government’s New Mobility initiative is all about. With the
support of the Rockefeller Foundation and in partnership with the MMDA, New Mobility
(we nickname it NeMo) is about making the business of mobility work: sustainably,
efficiently, and economically. We need the right incentives: on the demand side, for
flexible personal mobility through multiple options, and economic convenience and ease
of use; on the supply side, for sustainable income, disciplined driving, an emphasis on
Annex B
____________________________________________________________________________________
the need of the customer-commuter for reliable transit options, and openness to reform,
improvement, and innovation. Through NeMo, we hope to contribute to the
transformation of Metro Manila into a megacity truly on the move.
ANNEX C
 The iBoP Asia Program
Ateneo School of Government                                                                3/5/2012

                     Catalyzing New Mobility in Cities:
                        The Case of Metro Manila
                               Project Launching
                                Ateneo de Manila University
                                     January 31, 2012

                                                              with generous support from

                                        The iBoP Program
                                         Segundo Eclar Romero, PhD
                                              Director, iBoP Program
                                        Ateneo School of Government

                                                                                                 1
Ateneo School of Government                                                        3/5/2012

                                        The iBoP Concept

                   “Innovations at the
               Base of the Pyramid” in
                 Southeast Asia (iBoP
                                Asia)

                                     Two Concepts of BOP
                              • A socio-economic designation for the 4-5 billion
                                individuals that live primarily in developing
                                countries and whose annual per capita incomes
                                fall below $1,500 (in PPP terms); and
                              • An emerging field of business strategy that
                                focuses on products, services, and enterprises
                                to serve people throughout the base of the
                                world's income pyramid.
                              • Both concepts are also often referred to as the
                                “Base” or "Bottom of the Pyramid" or the "BoP".
                                         • -- http://www.brinq.com/resources/bop

                                                                                         2
Ateneo School of Government                                                                       3/5/2012

                              • Above the BoP are the MoP (Middle of the
                                Pyramid: annual incomes between $3,000 and
                                $10,000) and ToP (Top of the Pyramid: incomes
                                above $10,000 per year). Examples of ToP
                                populations would include much of the U.S.,
                                Europe, and the economic elite throughout the
                                world, while examples of the MoP would include
                                poorer people in developed nations as well as
                                the rising middle class in the developing world.
                                         • -- http://www.brinq.com/resources/bop

                                  The Base of the Pyramid (BOP)
                              •   A 5 trillion dollar, 4 billion person market with significant
                                  unmet needs
                              •   4 billion low-income people – the majority of the world's
                                  population – constitute the base of the economic pyramid
                                  (BoP). They live in relative poverty with an annual income
                                  below $3,000 and have significant needs resulting from,
                                  or impacting, climate change, the digital divide,
                                  malnutrition, hunger, health, poor sanitation or access to
                                  water.
                              •   Today's individualistic approach is collectively inefficient
                                  and, together with the dependency on donations, leaves
                                  the BoP fallow.
                              •   Low-income does not mean no income. Together, they
                                  have substantial purchasing power and represent a $5
                                  trillionglobal consumer market[1], suggesting a range
                                  opportunities for market-based approaches to better meet
                                  their needs and empower their entry into the formal
                                  economy.

                                                                                                        3
Ateneo School of Government                                                      3/5/2012

                                              iBoP Stakeholders
                                  •     Engage government, private
                                       sector, non-government, and
                                      international sectors: redirect,
                                      catalyze, and synchronize the
                                                    creative energies
                                            • Engage the poor and
                                                vulnerable sectors in
                                       Southeast Asia towards their
                                                   own development
                              •       The Program was established
                                      in 2007 with Dean Antonio La
                                        Vina as concurrently its first
                                                              Director

                                                   SEA countries
                              • The region is moving towards regional
                                integration (ASEAN 2015) as many SEA
                                countries have attained high economic growth
                                trajectories
                              • Increased innovation capacity in in Singapore,
                                Malaysia and Thailand drive this economic
                                growth and other countries aspire to jumpstart
                                their own innovation systems.

                                                                                       4
Ateneo School of Government                                                        3/5/2012

                              • Innovation policy in Southeast Asia, however, is
                                more focused on economic and industrial
                                development and less on poverty alleviation and
                                inclusive development.
                              • As economic growth increases, inequality also
                                increases and the poor and vulnerable suffer
                                unequal access to resources, basic services,
                                and employment opportunities.

                                       Innovations for Inclusive
                                                 Development
                              • Innovations must be purposively geared
                                towards inclusive development.
                              • “Innovations for inclusive development” (IID) is
                                understood as “innovation that reduces poverty
                                and enables as many groups of people,
                                especially the poor and vulnerable, to
                                participate in decision-making, create and
                                actualize opportunities, and share the benefits
                                of development.”

                                                                                         5
Ateneo School of Government                                                     3/5/2012

                              The iBoP Asia Program currently
                                 pursues a two track program
                              • Universities and Councils in Innovations for
                                Inclusive Development in Southeast Asia

                              • New Mobility in Metro Manila

                                            Early Insights

                              • Los Banos farmer, Purok Centro community
                              • Telecom – 97% with celfones and save time but
                                …
                              • Need to innovate and reinvent intermediaries,
                                including governments and universities)
                              • iBoP is about mindshift

                                                                                      6
Ateneo School of Government                                                        3/5/2012

                                 Other Program Areas of
                                        Concern
                              • The iBoP Asia Program is a new program.
                              • It aims to seek other opportunities and
                                pathways for promoting inclusive development,
                                including mobility, by enlarging its project
                                portfolio by seeking new partners and new
                                pathways towards inclusive development.

                                          The iBoP Team
                              • Within the Ateneo School of Government, the
                                iBoP Program belongs to the “Poverty” Key
                                Practice Area, with Assistant Dean Mary Jean
                                Caleda as focal person.
                              • The Director of the iBoP Program is Dr Segundo
                                E Romero. The Program Resource Group (that
                                provides support at Program as well as joint
                                support for the projects) consists of Ms Jessica
                                Bercilla, Senior Research Associate, Ms Cddqa
                                Rogel, Communications Associate, Mr Andre
                                Quintos, Web and System Administrator, and
                                Kristian Torres, Project Associate.

                                                                                         7
Ateneo School of Government                                                          3/5/2012

                                       iBoP Project Teams
                              • The UNIID-SEA Project Manager is Ms Grace
                                Santos, assisted by Ms. Lilac Caspe.
                              • The New Mobility Project Manager is Dr
                                Danielle Guillen, assisted by Mr Lorenzo
                                Cordova Jr, Research Associate.
                              • The iBoP Asia Team is a multidisciplinary team
                                that works with various centers in Ateneo such
                                as the Ateneo Innovation Center and the Ateneo
                                Center for Social Enterprise, various private
                                sector, non-governmental organizations, and
                                international organizations.

                                     Volunteers, OJT, Dissertation,
                                Thesis-writers, Practicum Students
                              • The iBoP Team encourages students,
                                volunteers, senior citizens, and other citizens to
                                participate in its programs and activities. The
                                iBoP Team is committed to providing
                                opportunities for service, learning, and
                                fulfillment to its stakeholders and partners.

                                                                                           8
ANNEX D
Universities and Councils Network for
Innovation for Inclusive Development
                     in Southeast Asia
3/5/2012

                   Universities and Councils Network
               for Innovation for Inclusive
               Development
               in Southeast Asia (UNIID-SEA)

REGIONAL CONTEXT:                   SOUTHEAST
ASIA

 Spectacular economic growth and
  increased poverty reduction over the last
  3 decades.
 Rising inequality

   (Gini coefficients of SEA countries: .34 –
  .44)

                                                             1
3/5/2012

REGIONAL CONTEXT:
INNOVATION and DEVELOPMENT
The innovation trajectory that led to rapid growth in SEA
(most evident in Singapore, Malaysia, Thailand) has tended
to exclude the poor and the social challenges that they
face, which exacerbates poverty and inequality.

                   REGIONAL CONTEXT:
                   INNOVATION and DEVELOPMENT

                              Social justice, equality
                              and human rights are not
                              deeply embedded in
                              innovation systems and
                              social/ political structures.
                              Development = economic,
                              industrial growth; social
                              development only
                              secondary.
                                                 Photo from www.sxc.hu

                                                                               2
3/5/2012

A NEW PERSPECTIVE:
INNOVATION FOR INCLUSIVE DEVELOPMENT
(IID)
              IID is understood as
        “innovation that reduces poverty
    and enables as many groups of people,
      especially the poor and vulnerable,
       to participate in decision-making,
    create and actualize opportunities, and
      share the benefits of development.”

            Innovation for all, by all.

           UNIID-Southeast Asia (UNIID-SEA)
       was conceived by the Innovation at the Base of the
       Pyramid in Asia (iBoP Asia) Program of the Ateneo
       School of Government and IDRC to:

                      Facilitate university and research council
                       reinvention for IID by integrating IID in the
                       core missions of teaching, research and
                       extension (university), and priority setting,
                       grant making and policy making (councils).
                      Establish formal and sustainable
                       partnerships and collaborations between
                       SEA universities and research councils, to
                       foster innovation research that links to/
                       informs social policy.
                      Form the UNIID-SEA Network of
                       universities and councils, and connect to
                       other UNIID networks (South Africa, Latin
                       America, South Asia).

                                                                             3
3/5/2012

     UNIID-Southeast Asia (UNIID-SEA), in the long
term,
   aims to foster
      Multidisciplinary, multi-stakeholder
       and multi-level (national, regional,
     global) approaches, mechanisms and
           partnerships towards IID.

      UNIID-Southeast Asia (UNIID-SEA)
    Identified partners and core network members

 UNIVERSITIES                            COUNCILS
 Ateneo de Manila University (PHL)       National Research Council of the
 School of Science and Engineering and   Philippines (LEAD ORG)
 School of Government (LEAD ORG)
                                         National Research Council of
 Chulalongkorn University (THL)          Thailand
 Department of Urban and Regional
 Planning                                Dewan Riset Nasional-Indonesia
 and Graduate School of Technology and
 Innovation Management                   National Council for S&T Policy
 Institut Teknologi Bandung (IND)        - Vietnam
 School of Architecture, Planning and
 Public Policy
 Hanoi University of Science and
 Technology (VNM)
 Faculty of Economics and Management

                                                                                  4
3/5/2012

     UNIID-Southeast Asia (UNIID-SEA)
    Network structure                         UNIID-LA, UNIID-South Africa, UNIID-South
                                              Asia

    HUST                           ITB           NRCT

                    ASoG         Technical Committee     NRCP                   DRN
                                  UNIID-SEA Project

    Chula                         AdMU

                                                        NRCV

CONNECTIONS: a) Intra- and inter-      SUPPORTED BY:
university                             Regional knowledge-building and
           b) Intra- and inter-council Information sharing platforms.
           c) Universities-Councils

    UNIID-Southeast Asia (UNIID-SEA)
   Key components/ activities for 2012-2015
               Knowledge- and
               Capacity-building                 IID Research Support
               - Baseline study of SEA
                                                 - IID Research Awards for
                universities and councils
             - Multidisciplinary IID Course             Universities
            Module and Open Courseware          - Innovation Challenge with
                    dev’t and piloting          Engineers Without Borders-
            - Social Innovation Lab (TBC)         Australia (in the pipeline)
            - IID Conferences with faculty
                       & students

                  Link to Policy
              - IID Workshops with                 Network-building
                     Councils                     - UNIID-SEA and UNIID
           - University-Council linkage              Global Consortium
        (i.e. harmonizing R&I agendas;
              policy research collab)
       - IID Agenda for ASEAN 2015

                                                                                                5
3/5/2012

                     UNIID-Southeast Asia (UNIID-SEA)
                     Work Program for 2012

                                                            YEAR 1
                Major Project Activities
                                                  Q1      Q2       Q3       Q4
            Baseline study of universities
            and universities in SE Asia
            Dev’t of web portal
            (UNIIDSEA.ibopasia.net)
            Project launch and Planning
            Workshop with partners
            (APRIL 2012)
            Dev’t of IID Course Module and
            Open Courseware
            IID Research Awards for
            Universities
            Workshop with Councils

    UNIID-Southeast Asia (UNIID-SEA)
   Project Team

                                                National Research Council
                                                of the Philippines

Dr. Segundo Joaquin Romero                 Dr. Cecilia Reyes
Program Director, ASoG-iBoP Asia           Executive Director, NRCP
Program                                    Project Manager – Council Component
Mary Grace Santos                          Carmen Moreno
Project Manager – University Component     Project Associate – Council
Lilac Caspe                                Component
Research Associate
Marie Cddyqa Jaya Rogel
Communications Associate
                                   Dr. Ellie Osir
                                   Senior Program Specialist
                                   Southeast and East Asia Program

                                                                                       6
3/5/2012

   UNIID-Southeast Asia (UNIID-SEA)

         Visit our web portal:
             www.ibopasia.net

              Contact us:
  Dr. Doy Romero: doyromero@yahoo.com
Grace Santos: mgpalaciosantos@yahoo.com
Trunklines: +632 426 6001 local 4639 or 4646
           Telefax: +632 929 70 35

                                                     7
ANNEX E
Catalyzing New Mobility in Cities Project:
   Finding New Mobility in Metro Manila
Ateneo School of Government                                                                                                                                     3/5/2012

                                                                                                     Background and Purpose

                                                                                                   • The Search focuses on the use of New
                                                                                                     Mobility as a lens in search of more
          Catalyzing New Mobility in Cities:                                                         sustainable and innovative solutions in the
              Finding NewMo in Metro Manila                                                          urban public transport system in Metro
                                  Project Launch                                                     Manila, in particular, ensuring that the needs
                                                                                                     of the poor and the vulnerable are met.
           SDC Auditorium, Social Development Complex, Ateneo de Manila University
                                       January 31, 2012

                                                                     with generous support from

              Some concepts
                                                                                                  New Mobility
                Mobility – is both the ability of a person (including
                the goods that the community needs) to travel to                                   • an initiative that is multi-disciplinary, multi-sector, top-
                destinations of choice and the amount of movement                                  bottom, bottom-up approaches like social enterprise
                and time necessary to do so.                                                       innovations in mobility addressing a socially inclusive
                                                                                                   transport sector
                Transportation- is the movement of people, animals
                and goods from one location to another. The field is                               • incorporates the dimensions of sustainability in
                divided into infrastructure, vehicle and operations.                               transportation such as social equity, economic, financial,
                                                                                                   health, ecology, physical environment, air quality, noise
                                                                                                   and climate change

                                                                                                   • based on the premise that as complexity increases, the
                                                                                                   notion that a single solution to solve transportation
                                                                                                   challenges decreases

               An engineer may envision
               solutions that include
               infrastructure or fuel but
               may not link them enough
               to urban design, policy and                                                        Goals & Objectives
               community behaviour.

                                                      An urban planner may develop
                                                                                                  • To develop a new platform, resource centre, and
                                                      ground-breaking approach to land            enabler of innovation for purposes of governance
                                                      use and urban design without                ensuring socially inclusive mobility in the region.
                                                      paying much attention to new
                                                      services like car-sharing, bike
                                                      sharing etc.                                    • to utilizeand complement existing studies by
                                                                                                      initiating a metro-wide conversation among
                                                                                                      stakeholders to introduce New Mobility and
                                                         An IT developer may come up                  find out how the stakeholders envision the
                                                         with unique system to fare                   future of transport system in Metro Manila.
                                                         payment, journey planning or
                                                         traffic mgt. but may not spend
                                                         time on linking to land use
                                                         policies.

                                                                                                                                                                      1
Ateneo School of Government                                                                                                      3/5/2012

                                                                       Finding “NewMo” (New Mobility) in
             Objectives                                                Metro Manila
             •to determine through research the impact and cost of     essentially means taking myriad steps that all
             the current public transport system on the poor and the   lead to a paradigm shift—
             vulnerable sector of the society (including BPOs)
                                                                       • by looking at the big picture
             • to identify new or emerging entrepreneurial or          •focusing on people’s needs and wants especially
             livelihood opportunities in the transport sector          that of the urban poor and the vulnerable
             responsive to the needs of the poor and the vulnerable    groups
             sector                                                    •evolution of transport as attention turned to
                                                                       energy efficient mobility models, shared
                                                                       transport schemes and community owned
                                                                       transport.

               NewMo Forum Series : Let’s Talk NewMo                   NewMo Forum Series : Let’s Talk NewMo

            • isa venue for people to habitually meet to
                                                                       •GOAL : to sustain a conversation among these
            share information, ideas, insights, and                    stakeholders about how citizens can be empowered
            initiatives for taking action at the community             to shape the patterns of mobility and access in
            level and increase the advocates of better                 Metro Manila to be more inclusive
            mobility and access to transportation in Metro
            Manila-especially for ordinary Manileña, the               •CHALLENGE: to promote non-motorized transport
                                                                       (NMT) such as walking and biking, public transport
            poor, and the vulnerable.
                                                                       (paratransit, buses, BRTs and trains), elimination of
                                                                       unnecessary travel through the smart use of
                                                                       traditional and cyber communications

               Researching NewMo in Metro Manila                         Engaging the General Public for
                                                                         NewMo
               Through research, the Project will
                                                                         Mapping for Inclusive Mobility: Pinpointing Transport
               •explore how the current public transport system          Hubs and Terminals
               affects the poor and vulnerable populations of Metro
               Manila by mapping the current public transport            -this activity aims to build a community of people
               system;                                                   wanting to create a platform or build on available
                                                                         platform to improve information generated in maps for
               •Understand the mobility patterns, cost and issues of     seamless multi-modal connections would benefit not
               the poor and the vulnerable groups;                       only the poor and the vulnerable groups but the
               •Seek new or emerging entrepreneurial or livelihood       general public
               opportunities responsive to their mobility needs.

                                                                                                                                       2
Ateneo School of Government                                                                                 3/5/2012

                 Search for “NeMo” Business Models:
                                                                                       iNewMo
                 “NeMo” Social Enterprise and Social
                 Innovations Awards                                                    1.inquiries
           •To surface enterprising solutions to solve social mobility
                                                                                       2.information
           problems                                                                    3.interest
           • To engage different stakeholders in solving pressing
           mobility problems in the megacity especially that of the
                                                                                       4.insights
           poor and the vulnerable sector                                              5.initiatives
           •To document existing social enterprises in the transport
           sector and generate innovative ideas that address mobility
                                                                                       6.innovations
           problems and needs.                                                         7.interconnections

                      Thank you!
                                Please contact:
                                Marie Danielle V. Guillen, PhD.
                                Manager
                                Catalyzing New Mobility in Cities: The Case of Metro
                                Manila Project
                                iBoP Asia Program
                                Ateneo School of Government
                                Telefax: 9297035
                                Email: NewMobility.Ph@gmail.com

                                                                                                                  3
ANNEX F
            Mapping for Inclusive Mobility:
Pinpointing Transport Terminals and Hubs
Ateneo School of Government                                                                                     3/5/2012

                       MAPPING FOR INCLUSIVE MOBILITY:
                        Pinpointing Transport Terminals and Hubs
                                           LORENZO V. CORDOVA, JR. EnP

                              Catalyzing New Mobility in Cities: The Case of Metro Manila
                                                    Project Launch
                          SDC Hall, Social Development Complex, Ateneo De Manila University
                                                   January 31, 2012

                                                                                   with generous support from

                                   KEY CONCEPTS
                              Modes of Public Transportation
                              Public Transport Hubs
                              Public Transport Terminals
                              Informal Transport Terminals
                              Engaging stakeholders in mapping

                                                                                                                      1
Ateneo School of Government                                                                 3/5/2012

                    Modes of Public Transportation in Metro Manila

                  Each plays major role in mobility especially of the poor and can either
                  compete or play complementary role to other forms of public
                  transportation

                                  Public Transport Hubs

                                                                                                  2
Ateneo School of Government                                                         3/5/2012

                              Public Transport Terminals

                     Informal Public Transport Terminals/ Hubs
                   Areas that are public or privately owned used by motorized and
                   non-motorized public transportation vehicles as terminals, but
                   have no clear legal provision and or local government
                   ordinances that support its existence.

                                                                                          3
Ateneo School of Government                                                         3/5/2012

                              Pinpointing Public Transport
                                  Terminals and Hubs
                    Metro Manila have complex and diverse transportation
                   modes.
                     Unaccounted public transport terminals and hubs.

                      We know they exist, but we lack readily available and
                   accessible information where they are.
                      Lack of capability of LGUs and other government agencies to
                   produce up-to-date maps
                      Mapping requires much time and resources.

                        Commuting in the Metro
                                        Connection points?

                          Choices?

                                              Efficiency?

                                                                                          4
Ateneo School of Government                                                                   3/5/2012

                           MAPPING FOR INCLUSIVE MOBILITY
                      Locating and mapping transport terminals are crucial in order to
                    assess the mobility problems and opportunities in Metro Manila.

                     Improving information generated in maps for seamless multi-
                    modal interconnections would benefit not only the poor and the
                    vulnerable groups but the general public.

                  Build a community of people wanting
                  to create that platform or build on
                  available platform.

                                Terminals (tricycle, jeepney, and bus)
                                in Brgy. Bagong Silang, Caloocan City

                  Tricycle terminals are located in many areas in the Barangay.
                  Bus uses vacant lot and roads as terminal.
                  The jeepney also uses the roadsides, vacant lots and rotonda as terminals

                                                                                                    5
Ateneo School of Government                                                                       3/5/2012

                 Findings:
                 • Excess of tricycle terminals (using walkability distance from HLURB of 200m)
                 • Tricycle terminals are either on the streets or shares space with pedestrian
                 sidewalks

                                  MAPPING FOR INCLUSIVE MOBILITY
                                           Individuals and organizations as
                                         contributors

                                             Intermediation platform – “enabler”

                                             Users

                                                                                                        6
Ateneo School of Government                                             3/5/2012

                   MOBILITY MAPPING – HI-TECH AND HI-TOUCH METHODS

                              • Some applications of ICT and existing
                              web-based platforms:

                                  Openstreetmap
                                  Google Map Maker
                                  SeeClickFix
                                  Cyclopath
                                  Waze
                                  Interaksyon.com & MMDA

                                                                              7
Ateneo School of Government                                                3/5/2012

                                 POSSIBLE INFORMATION FROM
                                        STAKEHOLDERS

                              • Mode of public transportation (tricycle,
                              pedicab, jeepney etc.)
                              • Location of terminal/ hub
                              • Name of TODA, JODA, PODA etc.
                              • Number of members
                              • Destinations/ Routes
                              • Time of operation
                              • Facilities and services available in the
                              terminals/ hubs

                   MAPPING FOR INCLUSIVE MOBILITY

                                                                                 8
Ateneo School of Government                                                                  3/5/2012

                               MAPPING FOR INCLUSIVE MOBILITY
                              • Locating and mapping these hubs and terminals will
                              improve the quality of information through
                              collaborative public process.
                              • Increase awareness among stakeholders of mobility in
                              Metro Manila especially the users of public
                              transportation.
                              • Expand useful data available data for decision-
                              makers while enabling much broader spectrum of
                              citizens to actively participate in citizen science in their
                              own communities, and to contribute their collective
                              opinions and decisions.
                              • This method increase efficiency to the generation of
                              data and reduce costs.

                               MAPPING FOR INCLUSIVE MOBILITY
                              • A community of people wanted to create or
                              build on existing platforms (“Prosumers”);
                              •Maps generated will be made available on-line -
                              a community resource and not proprietary in
                              nature;
                              • Should be able to generate discussion streams
                              on the state and improvements of the transport
                              system of Metro Manila.

                              • This is an evolving activity – new approaches
                              may become available over time

                                                                                                   9
Ateneo School of Government                3/5/2012

                              THANK YOU!

                                                10
ANNEX G
        Search for New Mobility
Business Models in Metro Manila
Ateneo School of Government                                                       3/5/2012

                 Catalyzing New Mobility in Cities:
                    The Case of Metro Manila
                      New Business Model Search
                                                     with generous support from

                                  Best “NeMo” Social
                              Innovation Concept Awards

                       • The entries in New Mobility social
                         innovations concepts/ideas and
                         solutions should be inclusive and at
                         the same time responsive to selected
                         mobility problem(s). The process is
                         solution-seeking task.

                                                                                        1
Ateneo School of Government                                                                             3/5/2012

                                     What Innovation?
                         • 'Product innovation’ – ideas on changes in the
                           things (products/services) addressing mobility
                           issues
                         • 'Process innovation’ – ideas on changes in the
                           ways in which mobility products and services are
                           created or delivered
                         • 'Position innovation’ – ideas on changes in the
                           context in which the new mobility
                           products/services are framed and communicated
                         • 'Paradigm innovation’ – changes in the
                           underlying mental models that address new
                           mobility issues
                                        Adapted from 4Ps of Innovation by John Besseant and Joe Tidd
                                                                         Humanitarian Innovation Fund

                                    Best “NeMo” Social
                                    Enterprise Awards
                              • The entries in best existing or
                                emerging social enterprise in the
                                transportation sector should be
                                responding to selected new mobility
                                problem(s) ,especially that of the poor
                                and vulnerable
                              • The entries must reflect sound
                                management and should be properly
                                documented

                                                                                                              2
Ateneo School of Government                                          3/5/2012

                              Specific Criteria for the Social
                                   Enterprise Awards

                              • Must be a social enterprise
                              • Must have a specific a
                                business model addressing
                                New Mobility concerns in
                                transportation of the poor
                                and vulnerable

                              Specific Criteria for the Social
                                   Enterprise Awards
                              • Must have a business model where
                                capabilities of the business,
                                public and citizen sector are
                                leveraged to deliver needed
                                goods and services to
                                marginalized populations such as
                                the Base of the Pyramid (BoP) with
                                the achievement of multiple
                                bottomlines as the end goal.

                                                                           3
Ateneo School of Government                                                     3/5/2012

                              Specific Criteria for the Social
                                   Enterprise Awards
                              The multiple bottom lines of the business
                              model include (but are not limited to):
                              • Surplus or profit generation, where profit is
                                reinvested for the gain of the stakeholders
                                and further pursuing the social objective
                              • Environmental health
                              • Preservation of cultural integrity and
                                diversity
                              • Capacitation or empowerment of a sector or
                                community simultaneously improving their
                                quality of life

                                  Example: Cargo bikes of
                                       WorldBike

                                                                                      4
Ateneo School of Government                                             3/5/2012

                              Mini-Bus Operation, Day Care Transport,
                               Special Education Needs Transport by
                                        the HCT Group in UK

                                Agency Community Transport Model and
                                     Transport Asset Management
                                           Riders for Health

                                                                              5
Ateneo School of Government                                  3/5/2012

                                Non-emergency Medical
                                Transport by Tranmedic

                              Example: Mobility Scooter by
                                     Rugged Tree

                                                                   6
Ateneo School of Government                                                      3/5/2012

                                        Common Criteria
                              Presentation
                              • Clear identification of mobility issues
                                being addressed especially with those of
                                the urban poor and the vulnerable groups
                              • Employ approaches that incorporate
                                principles of sustainability in transportation
                                that address issues in ecology, social
                                equity, health, finance and economy, air
                                quality, noise, climate
                              • Clear identification of challenges being
                                addressed and of success indicators

                                              Schedule
                              • Launch : January 2012
                              • Formal Calls for Nomination for: mid
                                Feb-Mar 2012
                              • Committee deliberation: April 2012
                              • Possibility for Presentation to
                                Rio Entrepreneurship Summit: May
                                2012

                                                                                       7
ANNEX H
New Mobility Initiatives of the MMDA
NEW MOBILITY INITIATIVES
   IN METRO MANILA
       ATTY. FRANCIS N. TOLENTINO
              MMDA Chairman

   CURRENT PROGRAMS
     AND PROJECTS

                                    1
1600 X 1400 CARLIFT
            6 PAX CAPACITY WITHOUT WHEELCHAIR

            5 PAX CAPACITY WITH WHEELCHAIR      FICEM BOARD CLADDING

                                                          GI SHEET ROOF

       SKYLIGHT ROOFING

                                                   ALUMINUM LOUVERS
     ROOF PLANTERS

                                                           900 mm DOOR OPENING
FICEM BOARD CLADDING

                                       • 1 meter high elevated
                                         platform
                                       • Automatic bus bay boarding
                                         gate and door with short
                                         range sensors
                                       • Customized bus floors
                                         aligned with the boarding
                                         platform
                                       • Manually operated ramps for
                                         the elderly and PWDs
                                       • CCTV cameras and alarms

                                                                                 2
• Macapagal Avenue
• Commonwealth Avenue
• EDSA (February 14, 2012)

Provides Traffic Advisories and Road Safety
       reminders to guide road users

                       EDSA Main Avenue (South Bound)

                                                        3
Consolidates the 85 existing provincial bus terminals with 60
 bus companies operating approximately 7,368 buses into 4
   common terminals (North, East, South and South East)

                            NORTH CORRIDOR

                                                 EAST CORRIDOR

                                               SOUTH EAST CORRIDOR
                            SOUTH CORRIDOR

                                                                     4
5
Maraming Salamat

                   6
ANNEX I
Responding to New Mobility Challenges in Quezon City
3/5/2012

 INTRODUCTION OF
ELECTRIC TRICYCLE
  IN QUEZON CITY

                          1
3/5/2012

  E-TRIKE PROGRAM OF THE DEPARTMENT OF ENERGY

1. DOE   is pushing for the shifting       to   a more sustainable
  and indigenous sources of fuel.

2. DOE is partnering with LGUs to formulate a program to be able
   to help    cities/municipalities acquire/adopt electric tricycles
   which
     will benefit tricycle drivers who are earning below the

      minimum wage
     will bring economic benefits from fuel savings or avoided cost

      on imported oil
     will have potential positive impact on the environment which

      will also    bring positive impact on the health of the people

3. The     “E-trike     Rent-to-Own Program,”       will    be
   designed jointly    by   the LGUs,      DOE,  ADB and     a
   government      financing     institution to be implemented
   nationwide.

         DOE PROPOSED LGU E -TRIKE RENT-TO-OWN
                       PROGRAM

                             E-Trike
                           Lessor/Bank

                              LGU
                                                                Remits
                                                                payment to
                           DPOS-TRU                             GFI on
                                                                agreed terms

                  E-TRIKE PMO      LGU - Coop

                            E-TRIKE
                                            Pays E-TRIKE RENT
                            DRIVERS         daily for the duration
                                            of the loan

                                                                                     2
3/5/2012

                                       E-TRIKE DESIGNS
                                             WITH
                                          DIFFERENT
                                       SPECIFICATIONS

                                            The E-Trike
                                         Program is a sub-
                                         program under the
                                          Fuel Sustainable
                                        Transport Program
                                        (FSTP) of the Dept.
                                             of Energy

    POTENTIAL DEMAND FOR THE ENTRY OF E-TRIKE IN METRO MANILA

                                       No. of TC Franchise in NCR, 2011
      Manila             2,535
 Quezon City                                                                 24,684
Mandaluyong                 3,833
    Marikina              3,159
       Pasig                            8,445
    San Juan       506
                                                                                                No. of TC
   Caloocan                                          14,750
                                                                                                Franchise,
    Malabon                         6,460                                                       NCR 2011
     Navotas         1,850
  Valenzuela                4,419
       Pasay             3,103                                                                 98,028
      Makati                4,262
   Las Pinas                  4,821
  Paranaque                   4,787
 Muntinlupa                  4,510
      Taguig                4,404
     Pateros         1,500
               0           5,000        10,000    15,000      20,000      25,000      30,000

                                                                                                                   3
3/5/2012

    DEPT. OF ENERGY’S PROPOSED INITIAL
 LIST OF POLICIES/REGULATIONS/ORDINANCES
 FOR IMPLEMENTATION BY LOCAL GOV’T UNITS

1.     Gradual phase-out of petrol-fed tricycles
2.     Provision of incentives for E-Trike
3.     Preferential franchise/route for E-Trikes
4.     Exemption from number coding scheme
5.     Readiness to set-up E-Trike related businesses
6.     Others

                                                     Pilot Test )
                                             (ELECTRIC TRICYCLES
                                                            -T     OR E   RIKES

                                             20 E-TRIKES
                                             (LITHIUM-ION   BATTERIES)

        10 Tricycles                              10 Tricycles
     • Price of e-Trike (more than $1,000)      • Full charge range 40-50 km
     • Full charge range 80-100 km              • 3 kWh battery (B units)
     • 6 kWh battery (A units)                  • Will use public street charging

     • Overnight 8-hour charge at home        • Fast charging in about 30 min

                                                                                          4
3/5/2012

Battery Choices
                                          Lead Acid
Pilot Test                                 $800
                                          Life: 200 charges

                                          140 kg
                                          slow-charge only

                                                72% lighter
                      Lithium Ion
                       $1,500
                      Life: 2,000 charges

                      40 kg
                      slow and fast-charge

 DAILY FUEL SAVINGS
 (DESKTOP STUDY ASSUMPTIONS)

Base Case:                                   E-Trike:
                       for every 100 km

Assumptions:                                  Assumptions:

                               about          20 km per kWh
20 km per Liter

5 liters for 100 km
50 Peso per liter
                        P200                  5 kWh for 100 km

                                                  10 Peso per kWh

>$5 or Peso 250
                                             >$1 or Peso 50

                                                                          5
3/5/2012

 RANGE RESULTS
 (“CONTINUOUS" RUNNING USING LITHIUM ION BATTERIES)

B4: 62.21 km
 3 KWh battery

      B7: 41.89 km
        3 KWh battery

         A2: 90.33 km
                 6 KWh battery

                                                 A1: 72.53 km
                                                         6 KWh battery

                                 Antipolo – Test Drive

                                                                               6
3/5/2012

TRANSFORMATION

                                                       The project is
                                                       about
                                                       creating a new
                                                       local industry
                                                       and local
                                                       employment

                                                       AND

                                                       Promotion of a
                                                       healthful and
                                                       balanced ecology

TRANSFORMATION THROUGH ENERGY EFFICIENT ELECTRIC
VEHICLE SYSTEMS – DELIVERING AN END-TO-END
INFRASTRUCTURE SOLUTION

100,000 electric tricycles
Cost   $400.0 million
                                         Electricity Demand
Savings:   $185 million per year         (peak-time charging)
(500,000 liters/ day  $500,000 / day)
                                         Demand:      6-60 MW peak
Avoided CO2 emissions                    Energy:      300,000 MWh
•      400,000 tons per year             Emissions:   160,000 tons

                                                                                7
3/5/2012

OUTPUT OF THE PROJECT

     Complete e-Trike units delivered to
      LGUs with standard 3-year warrantee
     Battery supply, installation, leasing
      and support infrastructure established
     Efficient motor supply chain created
     Public Charging stations installed in
      selected areas

TARGETS (MINIMUM)
By December 2012, at least:
   2 reputable motor suppliers;
   2 internationally reputable
    battery suppliers;             By December 2013, at least:
   6 e-Trikes suppliers with      • 3 internationally reputable
    service support; and              battery suppliers; and
   7,000 e-Trikes operating       • 15,000 e-Trikes operating

By December 2014, at least:        By December 2016, at least:
• 500 locally made charging        • 100,000 e-Trikes operating
    stations installed; and
•   50,000 e-Trikes operating

                                                                         8
3/5/2012

      MANAGEMENT OF THE OPERATION OF
    COMPLETELY BUILT ELECTRIC TRICYCLES
    DONATED BY ADB TO MANDALUYONG CITY
        KEY STAKEHOLDERS         COMPETITIVE ADVANTAGES OF THE USE OF
                                   E-TRIKE COMPARED TO CONVENTIONAL
1. The Asian Development Bank    TRICYCLE AS RECOGNIZED BY THE CITY OF
   As The Donor/Source Of                     MANDALUYONG
   Financing
2. Mandaluyong City As The       1. It is environment-friendly alternative.
   Operator
                                 2. It is relatively more spacious.
3. Selected Individual Driver-
   beneficiaries                 3. Does not require changing of oil.
4. Passsengers                   4. Use of E-trikes is expected to be cheaper.
                                 5. It is expected to increase the environmental
                                    awareness in the city.
                                 6. It is expected to significantly lessen air and
                                    noise pollution.
                                 7. Has available strategic charging stations.

                                                                                           9
3/5/2012

  COMPLETELY-BUILT E-TRIKE UNIT DONATED BY THE ADB

  DRIVERS AREA/FRONT                    LITHIUM-ION                  3 KILOWATT MOTOR
        PANEL                             BATTERY

   SIMPLE COMPARISON BETWEEN A STANDARD TRICYCLE AND E-TRIKE

 AREAS OF COMPARISON              CONVENTIONAL TRIKE                  ELECTRIC TRIKE
ACQUISITION COST                       P 80,000.00 cash or               P 200,000.00
                                  P 175,000.00 installment for          (approximately)
                                            3-5 years
NO. OF PASSENGERS                          3-4 people                   6-8 people max
                                      @ P 7.50/passenger              @ P 7.50/passenger
EXPECTED LIFE                            7 years will full                 Battery Life
IN YEARS                                  maintenance                  5.5 years/11 years
COST OF FUEL*                       P 250.00/8 hours/day or        P 45.00/6-8 hours/day or
(8-10 HOURS)                          P 7,500.00/month or            P 1,350.00/month or
                                        P 90,000.00/year               P 16,200.00/year
BOUNDARY COST                               P 150.00                        P 150.00
POTENTIAL GROSS                        P 800.00 (approx.)             P 1,600.00 (approx.)
INCOME/DAY
POTENTIAL NET                          P 400.00 (approximate)          P 1,405.00 approximate
INCOME/DAY**                           (P 146,000.00 per year)           (P 512,825.00/year)
* An E-Trike user may be able to save P 205.00/day or P 6,150.00/month or P73,800.00/year ,
   which for regular tricycle drivers normally spend more for gasoline
** Less fuel/electric expenses and boundary cost. Tricycles Operational/Repair Expenses are not
   included

                                                                                                       10
3/5/2012

     SUGGESTED E-TRIKE ACQUISITION-LIVELIHOOD PROGRAM
          (RENT-TO-OWN-PROGRAM) by Mandaluyong City

      OPERATIONS                             BOUNDARY
     (In 8 hours/day)
                                   Option 1                Option 2
                               P 150.00 per day        P 350.00 per day
In 30 Days / Month
                                   4 years                 1.5 years
Operations
In 24 Days / Month
                                   5 years                  2 years
(6 days a week)

   In 30 days operation, E-Trike drivers will own the unit in 4 years for P
    150.00 per day boundary/payment (Option 1) or 1.5 years for P 350.00
    per day boundary/payment (Option 2).
   In 24 days operation, E-Trike drivers will own the unit in 5 years for P
    150.00 per day boundary/payment (Option 1) or 2 years for P 350.00 per
    day boundary/payment (Option 2).

QUEZON CITY DESIGN ELECTRIC TRICYCLE

                                                                                    11
3/5/2012

       THE POSSIBLE WAY OF THE ENTRY OF E-TRIKES IN
     QUEZON CITY TO BE ABSORBED BY THE TRICYCLE SECTOR
           IS THROUGH REPLACEMENT/SUBSTITUTION
      REPLACEMENT/SUBSTITUTION of existing gasoline-fed tricycles with
      franchises with COMPLETELY-BUILT ELECTRIC TRICYCLE UNITS is open to
      any of the following conditions:
              Old and dilapidated 2-stroke and 4-stroke tricycle units
              Individual Franchise Holders who are willing to replace their existing tricycle unit/s
                with electric tricycle/s
              Selection of PILOT TODAs for the Initial Implementation of the “Rent-to-Own
               Program “

                                               Number of                  Number of Tricycle
                                          Tricycle Association                  Unit
                                                                           With Franchise
        District I                                     29                           4,736
        District II-A (NDC)                            38                           6,150
        District II-B (Main)                           30                           7,295
        District III                                   19                           2,668
        District IV                                    34                           3,835
                                Total                 150                          24,684

      OPTIONS ON THE PROPOSED ACQUISITION OF
        E-TRIKE UNITS AND DISPOSAL OF OLD
                 WITHDRAWN UNITS
1. Acquisition of E-trike units through financing options.
2. Trade-in of old tricycles with franchise for a new E-trike vehicles.
       The old tricycle unit shall be bought by the City Government and the amount shall serve as
          downpayment for the E-Trike.
       The City Government shall exercise all options in the disposal of the old tricycle units to
          recover the amount.
       The old tricycle units bought by the City Government may be donated to provincial
          municipalities where the beneficiaries are farmers who may use the unit to transport their
          farm goods to the market.
       The old tricycle units bought by the City Government may be donated to Sister Cities for their
          utility use.
3. Surrender of sidecar of tricycle unit with franchise for a new E-Trike vehicle.
       All withdrawn For-Hire units must be converted into a single motorcycle unit through an
          undertaking. The sidecars are to be surrendered and assessed by the City Government for its
          depreciated value and may serve as down payment for the electric tricycle.
       Withdrawn tricycle units which are converted into single unit as private classification shall no
          longer be fitted with sidecar and should not operate as For-Hire unit.

                                                                                                                12
3/5/2012

1. Gradual replacement and phase out of old petrol powered
  tricycles in five (5) years time.
    Pursuant to the Philippine Clean Air Act, the Quezon City
        Government plans to convert all gasoline-powered For-Hire
        tricycle units operating in the City into Electric Tricycles by
        2016 through a legislative measure.
    In line with the replacement to E-Trike is the
       withdrawal of all gasoline-powered tricycle units
       from all TODAs in Quezon City.
    No tricycle unit shall be allowed to operate as For-Hire in the City
        except electric tricycles.

2. Legislative measures should be formulated on the entry of
   and the promotion and sustainability of E-trikes in Quezon City.

                      THANK YOU!

                                                                                 13
ANNEX J
SMART Program and New Mobility Initiatives
             of the University of Michigan
3/5/2012

                                   1. CONNECTING THE DOTS
                                   (for livability, sustainability, equity)

                                   2. MOVING MONEY
                                   (innovation, access, jobs, enterprises)

                                   3. MOVING MINDS
                                   (new way of looking at transport & cities)

            Susan Zielinski, SMART, University of Michigan.
            January 30, 2012, Manila Philippines

LIVING LABS:
Bangalore
Beijing
Cape Town
Chennai
Cochin
Detroit Region
Fairfax
Los Angeles
Manila
Mexico City
Mystic
Pasadena
Portland
Seattle
Shanghai
Washington DC
Lisbon / Coimbra / Porto
etc…
Connecting the Dots; Moving Money; Moving Minds
RESEARCH, EDUCATION, TECH TRANSFER: ACCELERATE IMPLEMENTATION

                                                                                      1
3/5/2012

                    PARTNERS & SPONSORS:

                    National Science Foundation
                  Center for South Asian Studies
                 Transportation Research Board
                          Rockefeller Foundation
                                 Mott Foundation
                                  FIA Foundation
                                Alcoa Foundation
                           Ford Motor (redefining)
            US Environmental Protection Agency
                                   Cisco Systems
                                             IBM
                Federal Highway Administration
                   U.S. Department of Education
                                 CEO’s for Cities
                           City Connect Chennai
                Confederation of Indian Industry
                                            etc…

Why DID the chicken Cross the Road?

                                                           2
3/5/2012

   PURPOSE: Meet Needs - ACCESSIBILITY

   Live

   Love

   Work

   Play

   Other?

             Mobility* Technology * Proximity

                                                 (a la
                                         Texas Transportation
                        Mobility               Institute)

Transportation           Land-             Travel
   Capacity               Use             Demand
  Expansion             Planning         Management

                                                                      3
3/5/2012

           (North America-wide comparative study)
                New Innovation Opportunitites

                          Accessibility
                                                ENDS

                                  MEANS: New Mobility

    Mobility                 Proximity          Connectivity

BELLY OF THE BEAST ---- Transportation = Cars

(everything else it extraneous)

                                                                     4
3/5/2012

       Organ Donation Pledge

   I, ____________ (full name) wish to pledge the following organs
   ________________________ should I die as a result of this
   presentation.

   Date_______ Signature _____________________.
   Date_______ Signature of witness _____________.

In case you should die as a result of this presentation, please keep
this completed organ donor form in your wallet.

                                            “CAPTIVE”

                                “Transportation Disadvantaged”

                                                                             5
3/5/2012

Transportation = cars

(assuming transportation is necessary)

Therefore:

              CARS ARE NECESSARY

                   THEREFORE:

           to improve on transportation…

                        ???

                                                 6
3/5/2012

       LANGUAGE

       • Captive

       • Transportation Disadvantaged

       • Alternative modes (women alternative men)

       • Public transport cost (vs. investment)

       • TDM (sacrifice)

       • “Side” walks

       • Road closings (vs. openings)

       • Car use reduction (vs more options)

         Qualities of New Mobility:
                     …Like the Ideal Life’s Partner …

   Multi-talented      Sexy
   Clean               Innovative
   Connected           Saves money
   Integrated          Socially equitable
   Smart               Service-oriented
   Tech savvy          Creates jobs
   Sophisticated
                        Caters to your needs
   Confers status
   Convenient
                        Accessible to all
                        Other?

                                                              7
3/5/2012

  … as Thomas Friedman might say …
  TRANSPORTATION IS FLAT

  OPEN SOURCE, MULTI-MODAL, MULTI-SERVICE, IT ENHANCED USER FOCUSED, SOCIALLY
  EQUITABLE, AESTHETIC LIVABLE WHOLE SYSTEMS TRANSPORTATION

  TRANSLATION: More Choices; More Connected Choices (New Mobility)

  EMERGING GLOBAL NEW MOBILITY INDUSTRY TO SUPPLY IT
  The current value of New Mobility markets can be measured in the billions of dollars.”Building a New
  Mobility Industry Cluster in the the Toronto Region” (MTE & ICF)

                                                                             RESULT:
                                                                             Almost all
                                                                             transport
                                                                             has at least
                                                                             an urban
                                                                             component
CONTEXT: URBANIZATION

From 50% - 2/3 by 2025; 81% in US;
90 % world economy
Coming years: At least 35 cities more than 10 million

                                                                                                               8
3/5/2012

DRIVERS

                9
3/5/2012

                    BRT went
                     viral --
                    worldwide
                      More than 83
                    Over 40 in North
                     America alone

ZIPCAR: Wheels When You
Need Them
             services

 FRACTIONAL USE: AUTO RICKSHAWS, TAXIS & COMMUNAL
    CABS, INTERMEDIATE VEHICLES, CARSHARE, BIKE
        SHARE, SOCIAL NETWORKING, SLUGGING

                                                         10
3/5/2012

      new technology

      wayfinding; shared
      use; fare payment;
      traffic management;
      security etc.

Design & new
infrastructure

                                 11
3/5/2012

New modes / modal enhancements

                                      12
3/5/2012

moving people
moving goods
moving less

                     13
3/5/2012

                       VEOLIA Video

             CONNECTIVITY/OPTIMIZATIO
           CONNECTIVITY / OPTIMIZATION
                          N
               (both energy & time)
                           • spatial *
                    • spatial / physical

                  • service (use vs. own)

• technological (wayfind; fare pay; traffic manage; security)

• economic (revitalize; save $; create jobs; boost business)

                 • institutional & policy
                 (public private innovation)

        • cultural / psychological (moving minds)

                                                                     14
3/5/2012

 GAME CHANGE: SEAMLESSLY CONNECTED OPTIONS
 LEAPFROG: Straight to Next Generation Whole Systems Design & Build
 - spatial connectivity supported by New Technologies and PPI

 NEW MOBILITY GRID: More Choices, More Connected
 The Next Infrastructure; The Next Industry Cluster

 Transportation Meetings

0:00                                                            1:40 1:50 2:00

Agenda:          WHAT IS NOT WORKING
                                             Solutions Laundry List
                                          Quick attempts at prioritization
                                                                       Adjourn

  Attendees: Usual Suspects

                                                                                      15
3/5/2012

A heart? A lung? Pituitary gland? Your choice

What is better? What is the silver bullet?

I only use my heart I’m too rich and powerful to use my capillaries

                                                                           16
3/5/2012

             CONNECTIVITY/OPTIMIZATION
             IS THE NEW SILVER BULLET

            ROLLING OUT THE GRID: 4 STEPS
               (public-private innovation)
1. CONVENING – The Crucial & Often Under-Rated First Step
   (not just the usual suspects – public private innovation

2. MAPPING – An Engaging and Tangible Catalyst for Action

3. PILOTING & ROLL-OUT – Start with Hologram for Wider Spread Roll-
    Out

4. MOVING MINDS – Speak a new language (Rumi, Philip K. Dick)

5. NETWORK (SMART network – “twinning” for shared genius)

                                                                           17
3/5/2012

CONVENING

MAPPING

     and

PILOTING

           Washington, DC

           Ann Arbor, Michigan

                                      18
3/5/2012

         CHENNAI:
   Linking design, value
   capture, cycles, auto
 rickshaws, pedestrians,
   local business & new
     technologies (e.g.
 Mapunity, Cisco, Ashok,
          thru CII)

 COCHIN (quiet leapfrog)
Links train, metro, bus, ferry, auto, taxi, parking, 2 wheelers & cycles
Linked to commercial, entertainment, tourism, lifestyle
70% of people need not enter city (larger hubs gateways to grid of smaller hubs)
Transform economy & lifestyle
Sustainable – supported by real estate elements

                                                                                         19
3/5/2012

         Mexico City

CAPE TOWN – entrepreneurial ventures, way-finding,
workplaces, public-private innovation, moving minds

                                                           20
3/5/2012

Moving
Minds
Did Philip K. Dick predict or shape the future?

  SYSTEM OF SYSTEMS: CHANGES THE GAME

  Connects Mode Service Product Technology Design

   Door to Door (feeds trunk, focused on user)

   Scalable / incremental / ALL YESES / induces demand

   For all shapes & sizes of communities & regions

   Short term / long term (not land use / policy dependent)

   Appealing (design, cool status) & Safe & Equitable

   Resilient & Robust (to climate / geopolitical challenges)

   Business, Innovation, Job Opportunities
         (New Mobility Industry Cluster Multi-Billion $)

                                                                     21
3/5/2012

                      NEW MOBILITY ECONOMIC BENEFITS

                      Saves Money

                      Creates Jobs

                      Boosts Business

                      Revitalizes Local Economy

                                  TELECOMMUNICATIONS
                                      & WIRELESS
                  CLEAN ENERGY                          E- BUSINESS
                                                        & NEW MEDIA

     TRANSPORTATION                                                   INFORMATION
       EQUIPMENT                                                      TECHNOLOGY

FINANCIAL SERVICES,
                                                                              TOURISM
     BAN KING &
    INVESTMENT
                                  NEW MOBILITY                                & RETAIL

                                    INDUSTRY

                                                                      TRANSPORTATION
      GEOMATICS                                                         OPERATIONS
                                                                        & SERVICES

                   REAL ESTATE
                  CONSTRUCTION,                        GOODS MOVEMENT
                   PLANNING &                           & SUPPLY CHAIN
                   OPERATIONS          INTELLIGENT       MANAGEMENT
                                     TRANSPORTATION
                                         SYSTEMS

                                                                                              22
3/5/2012

     23
3/5/2012

             NEW ROLES (AND OPPORTUNTIES)

    PUBLIC SECTOR – incentives to connectivity / systems
     convening beyond the usual players / implementing,
   integrative frameworks / platforms to boost innovation &
                implementation. MOBILIZATION

    PRIVATE SECTOR – public-private innovation (action
    affects policy), new products, marketing New Mobility
            culture PUBLIC PRIVATE INNOVATION

   ACADEME – new models / tech transfer based on real
  world contexts, understanding & advancing solutions (not
    just problems). ACCELERATING IMPLEMENTATION

       NGO’s – informing / new approaches, partnering,
          engaging constituencies / implementing

                                          METRO MANILA

                           What Dots Are Already Connected?

                          What dots can be easily connected?

                                      What needs to be added
                                   (locally and system wide)?

    What benefits can be reaped? Social, ecological economic?

                              Who else should be at the table?

What policies, business models, marketing approaches can help
                                      address the challenges?

                                     When does the fun start?

                                                                      24
3/5/2012

             THE TRANSFORMATION BEGINS:

 STEP 1: NAME THE DOTS. ACCENTUATE THE POSITIVE

                       1 minute each

                       • Your Name

                    • Your effort / group

• The thing you’re most proud, happy, excited, hopeful about

    • One other person / group you’d bring to the table

                  SMART CONNECTIONS:

 • http://um-smart.org/blog or email me susanz@umich.edu

 • Living Labs (in pilot communities & regions) & NETWORK

           • Primer (Connecting & Transforming)

• Global Learning Community (education & capacity building)

• SMART Exchange collaborative tool -- smartumich.ning.com

                     • Business network

                  • Research collaborative

  • Regular gatherings / summits of the “systems” network

                                                                    25
ANNEX K
Updates/ Insights from the Rockefeller Foundation
3/5/2012

                     Why did the chicken
                      cross the road?
                             Why do we need
                         transportation anyway?

                                Seven Needs
1. It takes us where we want to go
2. It takes us when we want to go
3. It is a good use of our time
4. It is a good use of our money
5. It respects us with the level of safety, comfort
   and amenity it provides
6. We can trust it
7. It gives us the freedom to change our plans
Adapted from Jarrett Walker’s “Seven Demands of Transit” in Human Transit: How clearer thinking
about Public Transit can Enrich our Communities and Our Lives, Island Press, 2011.

                                                                                                        1
3/5/2012

To be a “lively, attractive, safe and
 sustainable city, [a city] must be
sweet to its pedestrians, sweet to
            its cyclists.”
                     Jan Gehl: Making Cities for People

                                                                2
ANNEX L
    How responsive is Metro Manila ’s
Public Transport System to the Needs
  of the Poor and Vulnerable Sectors?
      Insights from a Mobility Mapping
           Case Study of Metro Manila
3/5/2012

  How Mapping of the Public Transportation
   System can Respond to the Needs of the
              Poor and Vulnerable Sectors
                               JUN T. CASTRO, Dr. Eng.

                                     31 JANUARY 2012

INTRODUCTION

 3 Keywords: Mapping + Public Transport + Poor/Vulnerable

 Geographic Information System (GIS) mapping greatly
  enhances any planning study. Its graphical map-based
  interface, enhances data management and input capabilities.

 Several studies have used GIS for public transport planning,
  as well as urban poor community planning

 But limited studies on relationship of public transport and
  poor communities using mapping techniques

                                                                       1
3/5/2012

RESEARCH PROJECT GOALS

 Using GIS, identify, map and assess public transportation
   supply (modes, routes & facilities)

 Identify gaps in the data sets or barriers to access these data
   sets

 Assess the mobility of the urban poor and vulnerable sector
   in relation to transport supply

 Identify transport-related improvements in infrastructure
   and services that will benefit urban poor communities in the
   case study areas

TASKS AND ACTIVITIES

 Conduct secondary and primary data gathering

 Identify and formulate alternative mapping strategies for
   primary data collection
 Develop database of public transport hubs (i.e. bus,
   FX/GT Express, PUJs, tricycles), public transport and
   pedestrian networks
 Identify transport hubs (formal and informal) connecting
   urban poor communities in the study areas
 Map out public transit networks in the study areas

                                                                          2
3/5/2012

EXPECTED OUTPUT

 Documentation of process for generating, encoding, storing,
    sharing, and displaying user-friendly maps of public transport
    hubs/terminals:
     Using internet, i.e. open source mapping
     Using GIS
     Using interactive platforms

 GIS Database generated

 Decision maps to meet the needs of poor/vulnerable sectors
    in the case study areas

METHODOLOGICAL FRAMEWORK

Review of          Database              Spatial              Publishing of
Data               Development           Analysis             Results
                   • Existing            • Buffering/Proxi    • PT hub maps
• PT Supply
                     database              mity analysis      • PT network
• PT Demand
                   • Crowd-sourcing      • Overlay analysis     maps
• Informal
                   • Field surveys       • Network            • Pedestrian
  Settlements
                   • Questionnaire         analysis             walkways
                   • Validation, etc.                         • Decision maps

                                                                                      3
3/5/2012

REVIEW OF DATA
 Spatial mapping on public transport and pedestrian infrastructure
  (PT hubs (nodes), PT routes (links), Pedestrian facilities)
   MMUTIS (Metro Manila Urban Transport Integration Study),
     JICA (1999)
   MMUTSI (Metro Manila Urban Transport System Information),
     JICA (2005)
   MMPTS (Mega Manila Public Transport Study), JICA (2007)
   MMPTPSS (Mega Manila Public Transport Planning Support
     System Study), JICA (2012)
 Informal settlements
    Urban Poverty Morphology Project, Manila Observatory and
      Urban Research Consortium (2000)

DATABASE DEVELOPMENT

  CROWD-SOURCING/SMART MAPPING
  Discussed/To be discussed by:
   Mr. JayR Cordova in the AM session, and
   Ms. Susan Zielinski in the PM session

                                                                            4
3/5/2012

   DATABASE DEVELOPMENT
      VALIDATION OF COLLECTED       PHOTO DOCUMENTATION
     DATA THROUGH FIELD SURVEY

   DATABASE DEVELOPMENT

         GIS MAPPING

 effective way to visualize
   data and perform spatial
   analysis to identify
   relationships between map
   layers.

 validated data are digitized or
   converted into GIS data
   format (e.g., kmz to shp)

                                                                5
3/5/2012

    SPATIAL ANALYSIS
  Proximity Analysis/Buffering
    involves creation of areas
       around a geographical entity
       based on a measurement of
       distance

  Overlay analysis
    map layers are combined to
       form a new layer that
       provides new information
       derived from the attributes
       of the input layers

  Maps are the basis of both
    spatial and non-spatial decision-
    making

    PUBLISHING TO OPEN SOURCE MAPS

 Validated datasets to be
   published to open source
   maps (e.g. openstreet map,
   google earth map, etc.)

                                              6
3/5/2012

 SAMPLE TRANSIT MAP

 STUDY AREA

  Metro Manila to map out Public Transport terminals and
NORTH EDSA/AGHAM        MATANDANG BALARA              PAYATAS
    routes
     Crowd-sourcing activity
     Existing database from past studies (i.e., MMUTIS,
       MMPTS, MMPTPSS)

  Quezon City for case studies of poor/vulnerable communities

                                                                       7
3/5/2012

SOME PRELIMINARY RESULTS
NUMBER OF TERMINALS AND ROUTES FOR BUSES (1983/1996)

 MODES         ITEM        SERVICE AREA    1983     1996     1996/1983
   BUS      No. of        MM Intracity      197      150       0.76
            Routes
            No. of        Inside MM         121       35       0.29
            Terminals

            Estimated     MM Intracity     5,900    12,900     2.19
            No. of
            Operating
            Units

Source: 1983 JUMSUT & 1996 MMUTIS

SOME PRELIMINARY RESULTS
NUMBER OF TERMINALS AND ROUTES FOR JEEPNEYS (1983/1996)

 MODES           ITEM          SERVICE     1983      1996    1996/1983
                                AREA
 JEEPNEY      No. of        MM Intracity    780       490      0.66
              Routes

              No. of        Inside MM       184       210       1.14
              Terminals

              Estimated     MM Intracity   35,000   69,700      1.96
              No. of
              Operating
              Units

Source: 1983 JUMSUT & 1996 MMUTIS

                                                                               8
3/5/2012

    SOME PRELIMINARY RESULTS
    NUMBER OF TERMINALS AND UNITS FOR TRICYCLES (1983/1996)

      MODES          ITEM          SERVICE     1983     1996     1996/1983
                                    AREA
    TRICYCLE No. of             Inside MM       276      640       2.32
             Terminals

                  Estimated     MM Intracity   17,000   60,700     3.57
                  No. of
                  Operating
                  Units

    Source: 1983 JUMSUT & 1996 MMUTIS

SOME PRELIMINARY RESULTS
JEEPNEY AND TRICYCLE TERMINALS

Source: JICA 1999 MMUTIS

                                                                                   9
3/5/2012

SOME PRELIMINARY RESULTS
TRICYCLE TERMINALS IN QUEZON CITY

Total Number of TODAs = 150
    District 1 = 29
    District 2 = 68
    District 3 = 19
    District 4 = 34
No. of Units with Franchise
    District 1 = 4,727
    District 2 = 13,542
    District 3 = 2,668
    District 4 = 3,863

Source: Quezon City LGU

SOME PRELIMINARY RESULTS
PARTIAL MAPPING OF PT TERMINALS IN NORTH EDSA AREA

                                                     Informal
                                                     settlement

                                                                       10
3/5/2012

 CONCLUDING REMARKS
 Database and mapping can be useful in responding to the needs of the
   poor and the vulnerable groups
 GIS can be used as a tool to identify improvements in PT system
   Database development (using traditional and appropriate technology
      in data collection)
    Conversion of database to GIS (digitization, data conversion, etc.)
    Spatial analysis
    Application to planning (e.g., PT and pedestrian improvements, etc.)
      Whether poor is well served by PT system and pedestrian networks
      Whether transportation levels of service is above acceptable levels,
         etc.
    Decision maps to help planners and general public
      Seamless pedestrian walkway maps, PT service maps, etc.

           THANK YOU FOR YOUR ATTENTION

                                                           Jun T. Castro, Dr. Eng.
                                                             Associate Professor
                                       UP School of Urban and Regional Planning
                                                          nujortsac@gmail.com

                                                                                          11
ANNEX M
Case Studies on the Mobility Characteristics, Cost
    and Issues of the Poor and Vulnerable Groups
Ateneo School of Government                                                                       3/5/2012

                     Catalyzing New Mobility in Cities:
                        The Case of Metro Manila
                                Project Launching
                                 Ateneo de Manila University
                                      January 31, 2012

                                                                     with generous support from

                                 Case Studies on the
                              Mobility Characteristics,
                              Costs, and Issues of the
                                Poor and Vulnerable
                                              Groups

                                    Randolph D. Carreon, MATP, BSEcon
                                                               Transport Economist

                                                                                                        1
Ateneo School of Government                                                                           3/5/2012

                                      Objectives of the Study
                              •   The Study aims :
                                   – to understand the MOBILITY CHARACTERISTICS, COSTS
                                     AND ISSUES of the poor and vulnerable groups.
                              •   Specifically, the Study aims to:
                                   – establish the travel demand patterns of the poor and
                                     vulnerable groups;
                                   – look qualitatively into the efficiency of the public transport
                                     system vis-à-vis the needs of the poor and the vulnerable
                                     groups;
                                   – estimate the cost of mobility of the poor;
                                   – estimate the actual and desired cost of transport of those
                                     within the vulnerable groups; and
                                   – examine other non–quantifiable costs, if any, incurred by the
                                     vulnerable groups

                                        Who are the Poor and the
                                          Vulnerable Groups?
                              For purposes of this Study:

                                   – The “Poor” are those living within “colonies” of informal
                                     settlers.
                                       • Three (3) informal settler colonies in Quezon City as
                                          case study areas:
                                       a. Purok Centro, Barangay Old Balara
                                       b. Along Agham Road (North Triangle)
                                       c. GK Village in Barangay Payatas

                                   – The “Vulnerable Groups” will include (i) PWDs, (ii) Senior
                                     Citizens, (iii) Women and Children, and (iv) Business Process
                                     Outsourcing (BPO) workers.

                                                                                                            2
Ateneo School of Government                                                                3/5/2012

                                        Data Gathering Methodology

                              •   Household interviews in the three (3) informal
                                  settlement areas. Approximately 100 HH respondents per
                                  area.
                              •   The initial findings, based on the interviews, will be
                                  validated during a Small Group Validation Workshop
                                  (Public Consultation) in each of the area.
                              •   Individual interviews will be conducted with BPO
                                  workers.
                              •   Individual Interviews, Key Informant Interviews
                                  (KIIs) and Focused Group Discussions (FGDs) will
                                  be conducted with the other vulnerable groups.
                              •   Secondary data will also be collected.

                                                 Project Update
                                              Activity            Inclusive Dates
                                   Inception Meeting           27 October 2011
                                   Preparatory Works           Nov - Dec 2011
                                   Coordination with the       Mid – January 2012 to
                                   Case Study Areas            present
                                   HH Interviews               14 – 20 January 2012
                                   Public Consultation         27 January 2012
                                   Project Launch (including   31 January 2012
                                   Presentation of
                                   Initial Findings)
                                   Other Data Gathering        Feb – Mid March 2012
                                   Activities
                                   Completion of Analyses      Feb – March 2012
                                   Final Report                End – March 2012

                                                                                                 3
Ateneo School of Government                                  3/5/2012

                                    PROJECT ACTIVITIES AND
                                          INITIAL FINDINGS

                          Household Interviews

                          Public Consultation

                                                                   4
Ateneo School of Government                                                                                                                      3/5/2012

                                                                                    General Findings

                                                                                              •     No of HH in Purok Centro, Brgy Old Balara:
                                                                                                    414
                                                                                              •     Average HH Size:
                                                                                                    4.78 (say 5)
                                                                                              •     No of “From Home” Trips per Day:
                                                                                                    approx 1,000
                                                                                              •     No of Total Person–Trips per Day:
                                                                                                    approx 20,800

                       Trip Purpose of “From
                                    Home” trips

                                                            Modal Split (all person–trips)

                                                                                                          Walk                    31.10%
                                                                                                          Own Bicycle                   0.62%
                                                                                                          NMPT                          0.16%
                 40%
                                                 34.37%
                                                                                                          Tricycle                19.13%
                 35% 31.10%
                 30%                                                                                      PUJeep                  34.37%
                 25%
                                            19.13%
                 20%                                                                                      FX                            0.62%
                 15%
                 10%                                              8.09%
                                                                                  3.89%
                                                                                                          PUBus                         8.09%
                  5%          0.62% 0.16%                 0.62%           1.56%           0.16% 0.31%
                  0%                                                                                      Mass Transit                  1.56%
                                                                                                          Private Vehicle               3.89%
                                                                                                          Taxi                          0.16%
                                                                                                          School Service                0.31%

                                                                                                                                                       5
Ateneo School of Government                                                                                                                                                 3/5/2012

                                        Average Annual Income and
                                                 Expenses
                                                                                                 With Rent                                        No Rent
                                                                                      With MV               Without MV               With MV              Without MV
                                    Food                                                105,850.00             79,102.05                104,633.33              91,144.33
                                    Rent and Utilities                                  102,700.71             49,835.31                 45,933.85              41,680.65
                                    Communication                                          6,067.74                 8,162.01             14,796.54               6,871.30
                                    Education                                              3,392.63            10,897.05                 33,280.51              25,422.63
                                    Medical Care                                           3,590.73                 3,860.82             16,897.63              14,323.00
                                    Recreation and Vices                                 14,369.23             13,741.70                 31,763.08               7,183.10
                                    Transport                                         16,897.59 21,905.56 31,541.11 25,753.70
                                    Others                                               34,815.38             23,345.72                 22,849.94              15,314.00
                                    Total Annual Expenses                               287,684.00            210,850.21                301,695.98             227,692.71
                                    Average Annual Income                               271,040.00            203,138.11                269,002.80             167,261.10
                                     % of TC to AAI                                           6.23%                 10.78%                 11.73%                 15.40%
                                    % of TC to Total Expenses                                 5.87%                 10.39%                 10.45%                 11.31%

                                       Share of Transport Cost to Total Annual
                                                      Expenses
                                    350.00

                                    300.00

                                    250.00
                        Thousands

                                    200.00

                                    150.00

                                    100.00

                                     50.00

                                      0.00
                                                   With Rent - With MV             With Rent - Without MV           No Rent - With MV             No Rent - Without MV

                                       Transport     Food     Rent and Utilities     Communication      Education     Medical Care      Recreation and Vices    Others

                                                                                                                                                                                  6
Ateneo School of Government                                                                               3/5/2012

                               Breakdown of Annual Transport Cost

                                                    With Rent                        No Rent
                                              With MV      Without MV      With MV        Without MV

                        Fuel (Own MV)          6,083.33            0.00     7,735.19              0.00
                        Registration and
                        Maintenance(Own MV)    8,040.92            0.00     8,169.92              0.00
                        Fare (To Work)         2,773.33     10,905.56       8,996.00       14,430.00
                        Fare (To School)           0.00         4,500.00    6,640.00           7,857.03
                        Fare (To Market)           0.00         6,500.00        0.00           3,466.67
                                 Total        16,897.59     21,905.56      31,541.11       25,753.70

                                  Major Non-Monetary Cost: Safety

                                                                                                                7
Ateneo School of Government                                                                      3/5/2012

                              Perceived
                              Primary
                                                                  traffic  availability of
                              Mobility            long travel   congestion     public
                                                                    3%       transport
                              Problems               time
                                                      2%                      vehicles
                                                                                 2%
                                                                                     crowded
                                                                                       public
                                           high                                      transport
                                                                                      vehicles
                                        transport                                       2%
                                           cost
                                            91%

                              Proposed Solutions
                              (from Purok Centro)

                                1              work for additional income
                                2                      lower fare
                                3                   increase salary
                                4                         walk
                          Other Recommended Solutions:
                               • Cooperation of motorists
                               • limit number of passengers to vehicle's seating
                                 capacity
                               • private vehicle reduction
                               • provide efficient transport

                                                                                                       8
Ateneo School of Government               3/5/2012

                              Thank You

                                                9
ANNEX N
A Preliminary Inventory and Typology of Enterprise
      Models for Inclusive Mobility in Metro Manila:
           Of, By, and For the Poor and Vulnerable
Ateneo School of Government                                                                                     3/5/2012

                     Catalyzing New Mobility in Cities:
                        The Case of Metro Manila

                              By: Ateneo Center for Social Entrepreneurship (ACSEnt)
                                        SDC Hall, Social Development Complex
                                           Ateneo de Manila University
                                                 January 31, 2012
                                                                                   with generous support from

                                          Fashion Victim

                                                                                                                      1
Ateneo School of Government                                                                                            3/5/2012

                              Research Goals & Objectives
                              •   Mobility challenges of the poor and vulnerable sectors;
                              •   Existing (emerging) transport / mobility related social enterprise
                                  opportunities in the transport sector;
                              •   Sustainable innovative ideas and business models on new mobility and
                                  transport-related social enterprises – high potential for scale and
                                  replication, prescribed new mobility features, benefitting the poor and the
                                  vulnerable sectors;
                              •   Prescribe features of new mobility social enterprise models and
                                  incentive programs;
                              •   Market barriers and enablers :
                                    o Policy
                                    o Economics
                                    o Socio-Cultural
                              •   New platform, resource centre and enabler of innovation for a socially
                                  inclusive mobility in the region starting with Metro Manila

                                                                                          with generous support from

                              Scope
                              •   Focus
                                   – Commercial and enterprise component of the transport and
                                     new mobility sector
                              •   Key variables and indicators for output delivery
                                   – Barriers
                                   – Enablers
                              •   Methodology
                                   – Qualitative
                                   – Quantitative
                              •   Related Literature
                                   – Case studies and reports
                                   – Journals
                                   – Others
                              •   Output: expected output / “input” process from the framework
                                                                                          with generous support from

                                                                                                                             2
Ateneo School of Government                                                                        3/5/2012

                              Limitations

                              • Case Study: Metro Manila
                                 – Sampling: Quezon City Area (with high-
                                   density urban poor population and vulnerable
                                   sector), near major transport hubs

                              • Output
                                – Templating and modelling, features of social
                                  enterprise new mobility
                                – Not concrete business models – crowd
                                  sourcing
                                                                      with generous support from

                              Expected Outputs

                              • Mobility challenges of the poor and vulnerable
                              • Existing mobility models
                              • Emerging new mobility models – social
                                enterprises
                              • Social enterprise opportunities for the mobility
                                (transport) sector that will purposively benefit
                                the poor and vulnerable

                                                                      with generous support from

                                                                                                         3
Ateneo School of Government                                                                                          3/5/2012

                              Research Questions
                              1. What are the mobility challenges of the poor
                                 and the vulnerable sectors?
                              2. What are the existing mobility models?
                              3. What are the new mobility business
                                 innovations/approaches (including service
                                 models) that most effectively benefit the poor
                                 and vulnerable?
                              4. What are the barriers and enablers to
                                 implementation, replication and scaling up
                                 mobility innovations

                                                                                        with generous support from

                              Primary Considerations
                          •    Considerations for emerging new mobility sector:
                               - Efficiency (time to get from point A to point B)
                               - Cost (vulnerable/poor-friendly transport fare)
                               - Environmental
                               - Convenience and Safety
                               - Human-centered design principle

                          •    Proximate demands and supply for new mobility mechanisms

                          •    Mechanisms, infrastructures, systems that can support the various needs
                               and requirements of the new mobility consumers

                          •    Features of the new mobility system that will be convenient and helpful to
                               the consumers

                          •    Incentives, principles, barriers and enablers
                                                                                        with generous support from

                                                                                                                           4
Ateneo School of Government                     3/5/2012

                                  Linear

                              Design Thinking

                                                      5
Ateneo School of Government                                                                                                               3/5/2012

                                    Design

                     *INPUT PROCESS

                                                                                                                         *OUTPUT
                                        HUMAN-CENTERED

                                                                                                                        Innovation

                                                                                                                         Platform,
                                                                                                                         Resource
                                         DESIGN PROCESS

                                                                                                                          Enabler

                                                                                                                          Center,
                                                                                        *THROUGHPUT
                                                                                          (DELIVERY)
                                                                                           PROCESS
                                                                       BARRIERS /
                                                                       ENABLERS
                                              Design Possibilities

                                                                                                     Capacity Dev’t &
                                                                                                     Implementation
                                                                                                                           Vulnerable
                       Approaches
                       SE Models/

                                                                                        Custom-fit
                                                                                                                             sector-

                                                                                                         Design
                                                                                                                             friendly
                                                                                                                            mobility
                                                                                                                         infrastructure
                                                                                                                              design

                                                                                                                        Monitoring and
                                                                                                                         Sustainability
                                                                                                                           Measures

                                                                                                                        *OUTCOME

                                    Methodology
                                    •     Data Gathering
                                           – Multimethodology: Mixed Approach Design (MADS)
                                    •     Primary data gathering
                                           – Quantitative
                                                 • Survey
                                                 • Area sampling
                                           – Qualitative
                                                 • Secondary data analysis and review of related literature
                                                 • Focused group discussion
                                                 • Interview with key informants
                                                 • Community consultation
                                    •     Validation and analysis
                                           – Triangulation methodology
                                           – Hybrid data gathering methodology: Human-centered Design
                                               (quanti-quali cross-validation approach)

                                                                                                            with generous support from

                                                                                                                                                6
Ateneo School of Government                                                                        3/5/2012

                              Operational Variables & Definitions
                              • Business model

                               depicts the rationale of how organizations
                                identify key strategic variables and measures
                               blueprint for the organization’s business strategy
                               architecture of the organization that includes the
                                core aspect of the business

                                                                      with generous support from

                              Operational Variables & Definitions
                              • Social entrepreneurship

                              As an activity:

                              the activities in which organizations engage to
                              achieve socially-beneficial and inclusive objectives
                              and pursue the mission through sustainable
                              resource mobilization strategies

                                                                      with generous support from

                                                                                                         7
Ateneo School of Government                                                                     3/5/2012

                              Operational Variables & Definitions
                              • Social entrepreneurship

                              As an approach/methodology:

                              an innovative and system-changing approach in
                              solving pervasive social problems through
                              sustainable entrepreneurial practices

                                                                   with generous support from

                              Operational Variables & Definitions
                              • Social entrepreneurship

                              As a business model: a business model where
                              capabilities of the business, public and citizen
                              sector are leveraged to deliver needed goods and
                              services to marginalized populations such as the
                              Base of the Pyramid (BoP) with the achievement
                              of multiple bottomlines as the end goal.

                                                                   with generous support from

                                                                                                      8
Ateneo School of Government                                                                        3/5/2012

                              Operational Variables & Definitions
                              • Social enterprise

                              In general: Social enterprises are organizations
                                that engage in social-mission driven initiatives to
                                address pervasive social problems and close
                                this gap through an innovative, system-
                                changing and wide-scale approaches. These
                                are organizations that are involved in activities
                                whose main stakeholders are the marginalized
                                sector and come up with sustainable resource-
                                mobilization strategies to achieve multiple
                                bottomline goals.
                                                                      with generous support from

                              Operational Variables & Definitions
                              • Social enterprise

                              By nature: Social enterprises can be identified as
                                organizations whose social mission is
                                consciously embedded within its structure,
                                governance and core aspect of the business.
                                The social gain is not just an “auxiliary” activity
                                (such as CSR or community outreach missions)
                                of the entire business operation, but rather
                                embedded as integral to its business model and
                                strategy

                                                                      with generous support from

                                                                                                         9
Ateneo School of Government                                                                       3/5/2012

                              Operational Variables & Definitions
                              • Social enterprise

                              By social aims and outcomes: Social enterprises
                                explicitly attempt to close the gap by providing
                                innovative solutions to pervasive social
                                problems that the public, private and traditional
                                citizen-sector failed to address.

                                                                     with generous support from

                              Operational Variables & Definitions
                              • Social enterprise

                              By stakeholder-focus: Social enterprises are
                                organizations that are mainly focused on the
                                marginalized sector such as those in the bottom
                                of the pyramid (BoP), physically disadvantage,
                                and so on, and create opportunities where these
                                stakeholders are the primary consumers,
                                market drivers or leadership base of the
                                organization itself.

                                                                     with generous support from

                                                                                                       10
Ateneo School of Government                                                                           3/5/2012

                              Operational Variables & Definitions
                              • Social enterprise

                              By leadership and sectoral-base: Social enterprises are
                                led by individuals, groups or communities that are
                                not main actors within the public or corporate sector.
                                However, this particular social enterprise typology
                                must not be misconstrued with its definition in terms
                                of legal status. Social enterprises can be led by
                                private individuals or groups as well as the citizen
                                sector who have started the organizations as
                                independent from government agencies and the
                                traditional corporate business units.

                                                                         with generous support from

                              Operational Variables & Definitions
                              • Innovation

                              As a process: innovation is the process by which
                                unconventional ideas or ways of doing things
                                are translated or created to achieve
                                revolutionary systems-change

                              As an outcome: is the result or by-product of a
                                process that offers new systems, infrastructures
                                and processes of doing things

                                                                         with generous support from

                                                                                                           11
Ateneo School of Government                                                                    3/5/2012

                              Operational Variables & Definitions

                              • Barriers / Enablers

                              1. Policy: standards and regulatory mechanisms
                              2. Economic: market model, supply-demand
                              3. Socio-cultural: human ecology, cultural
                                 anthropology, patterns of behavior, social
                                 context

                                                                  with generous support from

                               Pre-test Data Gathering

                                                                  with generous support from

                                                                                                    12
Ateneo School of Government                                                                           3/5/2012

                              Preliminary Findings
                              • Key Mobility Challenges of the Poor and
                                Vulnerable
                                 – Cost
                                 – Length of travel
                                 – Travel time
                                 – Challenges in terms of access to basic goods
                                   and services are not due to lack of transport
                                   modes, but in terms of the cost of goods itself
                                   (indirect influence due to cost of transport)

                                                                         with generous support from

                              Preliminary Findings
                              • Supply-demand study on transport/mobility
                                products and services

                                 ICT Access                  Affordability

                                                                         with generous support from

                                                                                                           13
Ateneo School of Government                                                                                                                  3/5/2012

                                          Preliminary Findings
                                          • Supply-demand study on transport/mobility
                                            products and services

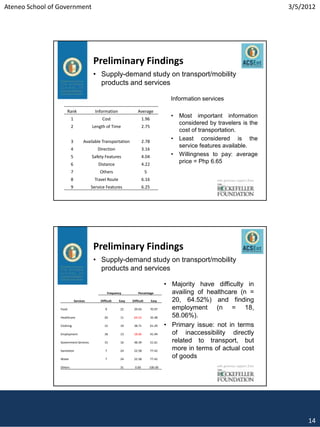

                                                                                              Information services

                     Rank                  Information                 Average
                          1                    Cost                         1.96
                                                                                              •   Most important information
                                                                                                  considered by travelers is the
                          2              Length of Time                     2.75
                                                                                                  cost of transportation.
                          3         Available Transportation                2.78
                                                                                              •   Least considered is the
                                                                                                  service features available.
                          4                 Direction                       3.16
                          5              Safety Features                    4.04              •   Willingness to pay: average
                          6                 Distance                        4.22
                                                                                                  price = Php 6.65
                          7                  Others                            5
                          8               Travel Route                      6.16                                with generous support from
                          9              Service Features                   6.25

                                          Preliminary Findings
                                          • Supply-demand study on transport/mobility
                                            products and services

                                                                                            • Majority have difficulty in
                                                     Frequency         Percentage             availing of healthcare (n =
                              Services        Difficult     Easy   Difficult       Easy       20, 64.52%) and finding
                 Food                            9           22     29.03          70.97      employment (n = 18,
                 Healthcare                      20          11     64.52          35.48      58.06%).
                 Clothing                        12          19     38.71          61.29    • Primary issue: not in terms
                 Employment                      18          13     58.06          41.94      of inaccessibility directly
                 Government Services             15          16     48.39          51.61      related to transport, but
                 Sanitation                      7           24     22.58          77.42      more in terms of actual cost
                 Water                           7           24     22.58          77.42
                                                                                              of goods
                 Others                                      31      0.00          100.00                       with generous support from

                                                                                                                                                  14
Ateneo School of Government                                                                                        3/5/2012

                              Preliminary Findings

                                                                          Frequency             Percentage

                                            Reasons                      Yes     No            Yes          No

                   • 24 (77.42%)            Distance                     13       18         41.94        58.06

                     attribute their        Price (to costly to
                     difficulty towards     travel)                      14       17         45.16        54.84

                     the cost of availing
                     of these goods and     Price (to costly to avail)   24       7          77.42        22.58

                     services.              Access                       12       19         38.71        61.29

                                            Others                                31          0.00       100.00

                                                                                      with generous support from

                              Preliminary Findings
                              • Existing and Emerging Mobility Models and
                                Case Studies

                              Recurring themes and features:
                              • Sustainable transportation
                                 – sustainable targets
                                 – sustainable legislation for transportation and
                                   land coordination policies/ designs, inter and
                                   intra-agency collaboration approach, agency
                                   prioritization and allocation process
                              • Energy efficient
                                                                                      with generous support from

                                                                                                                        15
Ateneo School of Government                                                                                    3/5/2012

                              Preliminary Findings
                              • Existing and Emerging Mobility Models and
                                Case Studies

                              Recurring themes and features:
                              • Multi-modal mobility
                              • Multi-stakeholder approach
                              • Human patterns of movement
                              • Predictability of movement of goods and people
                              • Minimizing cost

                                                                                  with generous support from

                              Preliminary Findings
                              •   Barriers and Enablers

                                   – Policy: uncoordinated, fragmented, unsustainable policy and
                                     regulatory frameworks do not offer support for the
                                     development of sustainable pro-poor mobility structures

                                   – Economics: current economic incentives are mostly private-
                                     sector biased, mobility models are designed not to cater to
                                     human needs but for achievement of bottomline profit

                                   – Socio-cultural: urban development and transport system
                                     designs in MM are out of sync with patterns of settlement,
                                     human ecology, consumer behaviors, unsustainable land
                                     and resource planning

                                                                                  with generous support from

                                                                                                                    16
Ateneo School of Government   3/5/2012

                                   17
Ateneo School of Government   3/5/2012

                                   18

Project Launch Documentation

  • 1.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 JANUARY 2012 SOCIAL DEVELOPMENT COMPLEX AUDITORIUM ATENEO DE MANILA UNIVERSITY, LOYOLA HEIGHTS, QUEZON CITY
  • 2.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 Social Development Complex, Ateneo de Manila University, Loyola Heights Quezon City
  • 3.
    Table of Contents ExecutiveSummary I. Opening Program A. Welcome Remarks by Dean Antonio La Viña, ASoG II. Overview of the Innovations at the Base of the Pyramid in Southeast Asia Program (iBoP Asia) III. Presentation of iBoP’s Key Projects A. Universities and Councils Network on Innovation for Inclusive Development in Southeast Asia (UNID-SEA) B. Catalyzing New Mobility in Cities Project: Finding NewMo in Metro Manila IV. iBoP Asia Website: iFind NewMo V. Mapping for Inclusive Mobility: Pinpointing Transport Terminals and Hubs VI. Search for New Mobility Business Models in Metro Manila VII. Sharing the New Mobility Agenda A. Search for New Mobility Opportunities in AdMU B. New Mobility Initiatives of the MMDA C. Responding to New Mobility Challenges in QC D. SMART Program and New Mobility Initiatives of the University of Michigan VIII. Open Forum IX. Updates/ Insights from the Rockefeller Foundation X. Understanding the Challenges and Opportunities in New Mobility A. How responsive is Metro Manila ’s Public Transport System to the Needs of the Poor and Vulnerable Sectors? Insights from a Mobility Mapping Case Study of Metro Manila B. Case Studies on the Mobility Characteristics, Cost and Issues of the Poor and Vulnerable Groups C. A Preliminary Inventory and Typology of Enterprise Models for Inclusive Mobility in Metro Manila: Of, By, and For the Poor and Vulnerable XI. Open Forum XII. SMART Mapping Uncharted Connection Points in Metro Manila: The Participatory Mapping Workshop Approach and Process i
  • 4.
    XIII. Annexes A. List of participants for Project Launch B. Moving Metro Manila – Eagle Eyes by Dean Tony La Viña C. Overview of the Innovations at the Base of the Pyramid in Southeast Asia Program (iBoP Asia) Presentation slides D. Universities and Councils Network on Innovation for Inclusive Development in Southeast Asia (UNID-SEA) Presentation slides E. Catalyzing New Mobility in Cities Project: Finding NewMo in Metro Manila Presentation slides F. Mapping for Inclusive Mobility: Pinpointing Transport Terminals and Hubs Presentation slides G. Search for New Mobility Business Models in Metro Manila Presentation slides H. New Mobility Initiatives of the MMDA Presentation slides I. Responding to New Mobility Challenges in QC Presentation slides J. SMART Program and New Mobility Initiatives of the University of Michigan Presentation slides K. Updates/ Insights from the Rockefeller Foundation Presentation slides L. How responsive is Metro Manila ’s Public Transport System to the Needs of the Poor and Vulnerable Sectors? Insights from a Mobility Mapping Case Study of Metro Manila Presentation slides M. Case Studies on the Mobility Characteristics, Cost and Issues of the Poor and Vulnerable Groups Presentation slides N. A Preliminary Inventory and Typology of Enterprise Models for Inclusive Mobility in Metro Manila: Of, By, and For the Poor and Vulnerable Presentation slides O. Photo Documentation ii
  • 5.
    List of Acronyms ADB - Asian Development Bank AdMU - Ateneo de Manila University ASoG - Ateneo School of Government AUVs - Asian Utility Vehicles BoP - Base of the Pyramid BRT - Bus Rapid Transit COA - Commission on Audit DOE - Department of Energy DOTC - Department of Transportation and Communication DPWH - Department of Public Works and Highways E-trike - electric tricycle FGD - focus group discussion GIS - Geographic Information System GK - Gawad Kalinga iBoP Asia - Innovations at the Base of the Pyramid in Asia Program IID - Innovation for Inclusive Development IMMAP - Internet and Mobile Marketing Association of the Philippines IT - Information Technology KII - key informant interview LED - Light Emitting Diodes LGUs - Local Government Units LTFRB - Land Transport and Franchising Regulatory Board MIS - Management Information System MM - Metro Manila MM-PIBAS - Mega Manila Provincial Integrated Bus Axis System MMDA - Metropolitan Manila Development Authority MRT - Metrorail Transit MV - motor vehicle NewMo - New Mobility NGO - Non-Government Organization PT - Public transport/ public transportation PUJ - Public Utility Jeepney PUVs - Public Utility Vehicles PWDs - Persons with Disabilities iii
  • 6.
    QC - Quezon City RnD - Research and Development SE - Social Enterprise SEA - Southeast Asia TAN - Transparency and Accountability Network TODA - Tricycle Operators and Drivers Association UNIID - Universities and Councils Network on Innovation for Inclusive Development UP-NCTS - University of the Philippines National Center for Transportation Studies US - United States iv
  • 7.
    Executive Summary A totalof 41 various organizations and 104 individuals working on transportation in Metro Manila attended the project launch held last 31 January 2012 at the Social Development Complex Auditorium of the Ateneo de Manila University attended the launching of the “Catalyzing New Mobility in Cities: the Case of Metro Manila” project. With support from the Rockefeller Foundation, this undertaking was organized by the Innovations at the Base of the Pyramid in Asia (iBoP Asia) Program of the Ateneo School of Government. The aim of the launch is for the stakeholders to look at the big picture and see how organization and infrastructure are connected and how these can make the difference. It is a paradigm shift of looking at how people really move and how one can make a difference. It is strong on having options that includes walking and cycling. The project hopes to ignite the goal of sustaining a conversation among stakeholders on how citizens can be empowered to shape the patterns of mobility and access in Metro Manila to be more inclusive. It is expected that the Metro Manila stakeholders, are motivated to actively contribute to their own enhanced mobility by taking advantage of the constituency-awareness, -building, and -mobilizing opportunities presented at the project launch. The earlier insights of the iBoP Program were people say no to innovation because of the price they had to pay for making change happen and that universities are not geared toward the promotion of innovation because they are too divided into multi-disciplinary silos thus, could not fuse themselves together. With the initial results of commissioned researches in New Mobility project, the following were some of the understanding of those on the ground about innovation: 1) that the community was being census and may be asked to move out from their place; and 2) the project might lead to improvements that might attract informal settlers from other areas. These two experiences on the ground made the project team realize that the community is afraid of progress and that the burden of understanding is with the project people and not that of those in the base of the pyramid. Some important highlights of the New Mobility project include: 1. New Mobility Forum/Workshop/Lecture Series that serves as a venue for people to habitually share information, ideas, insights, and initiatives for taking action at a community level and increase advocates for mobility and access to transportation in Metro Manila. 2. The project has a research component that seeks to explore the impact of the current public transport system especially the poor and the vulnerable population of Metro Manila by mapping the current public transport system and understanding the mobility patterns, cost and issues of the poor and the vulnerable groups. 3. The search for New Mobility Business Models: New Mobility Social Enterprise and Social Innovations Award where the project will accept related initiatives, concept, ideas and solutions specifically addressing mobility problems in Metro Manila.
  • 8.
    4. iFind NewMobility webpage in the iBoP website that features everything or anything related to new mobility including blog entries, links to other websites, latest news on mobility and an update of project’s activities. 5. Mapping for inclusive mobility: pinpointing public transport terminals and hubs using the hi-touch and hi-tech methods can improve the quality of information through a collaborative process. These also increases awareness among stakeholders, expand useful data available data for decision makers while enabling much broader spectrum of citizens to actively participate in citizen science in their own communities and to contribute their collective opinions and decisions. Hopefully these methods would increase efficiency to the generation of data and reduce costs while creating a community of people building on existing platforms. The information generated will be available on-line, not proprietary, and should start discussion streams on the state and improvements of the transport system in Metro Manila. Other partners and stakeholders also shared their respective new mobility agenda as follows: 1. The Ateneo de Manila University presented by the University President, Fr. Jose Ramon Villarin, shared its vision of making the campus a sustainably mobile campus and its hopes of making it a carless campus. He also shared that there are plans for pedestrianizing the campus and starts including talks on mobility especially with students specializing on environment 2. The Metropolitan Manila Development Authority Chairman Francis Tolentino presented all their projects that address new mobility issues in Metro Manila. Some of their key projects include: construction of bicycle lanes from Remedios Circle to Intramuros, construction of pedestrian friendly foot bridge to be piloted in Sucat, elevated loading and unloading bus bays, motorcycle lanes along EDSA, LED Message Boards, Mega Manila Provincial Integrated Bus Axis System, Vehicle Tagging, Metro Manila Traffic Navigator, and the EDSA makeover project. He also noted the h importance of utilizing the esteros for transport purposes. 3. The local government of Quezon City presented by Retired Brig. Gen. Elmo San Diego, Head of the Department of Public Order and Safety of Quezon City, shared the electric tricycles (e-trike) program in cooperation with the Department of Energy and Asian Development Bank. It is a rent-to-own nationwide program designed jointly by LGUs, DOE, ADB and government financing. The basic requirement is to trade conventional tricycle with e-trikes. He also shared the Open Katipunan (OK) project that they planned to implement with Ateneo. Ultimately, the goal of project OK is to reduce cars traversing along Katipunan in half. Some of the issues/concerns raised by the participants were the following: 1. The framing of the poor and vulnerable: The use of the terms “poor” and “vulnerable” versus “commuter” or “general public”. Whereas, “poor” is an economic condition while “vulnerability” is a physical and social condition. The poor and vulnerable should not be separated from the general public but be coiled into one term: “commuters”.
  • 9.
    2. The operationof electric tricycles and how it improves mobility:Such as the cost of operation, what to do with the electronic waste generated in using lead acid for operation. 3. The issues on making cities more walkable such as safety, health and monitoring.:Most of the mobility innovations are centered on vehicles despite the fact that walking is considered to be the most important mode of transport especially for the poor. Health-wise, make cities more walkable by also not endangering the health of the citizens. 4. The idea of citizen or community involvement:Bringing action down to the barangay level might yield quicker and: better result than relying on government alone. The proper mind shift is that innovation is not always the government’s role. If the community can do something, they must act on it. Advocate for social accountability. 5. The mapping components and its accessibility When mapping out transport hubs and terminals, consider the flood zone areas, sitios and barangays rather than street names and the vulnerable sectors like the senior citizens and persons with disabilities. In terms of accessibility, a discussion on all levels of access to information from gathering of data to publishing. Printed copies of the maps compared to posting on the internet may be more practical and are much acceptable to people. In order to understand the challenges and opportunities of new mobility in Metro Manila, preliminary data of the three commissioned case studies were presented. For the mapping study, which tackles the question, how mapping can be used to respond to the needs of the poor and vulnerable, Dr. Jun Castro presented both in numerical and visual form partial mapping of the public terminals in North EDSA. In the study on mobility characteristics, costs and issues of the poor and vulnerable groups, Mr. Randolph Carreon showed photo documentation of their data gathering and general findings in Purok Centro, Matandang Balara, Quezon City. The data showed that people primarily leave their house to go to work and school. Of the estimated total of 20,000 trips per day, aside from walking, the top 2 transport modes used are PUJ and tricycle. Generally, the people said they would walk if they could. The perceived primary mobility problem of the Purok Centro Matandang Balara community was high transport cost, which they thought they could resolve by raising their income. Lastly, the Ateneo Center for Social Entrepreneurship represented by Ms. Tieza Santos, is commissioned to look at existing transport/ mobility related social entrepreneurship opportunities in the transport sector presented a summary of pretest data gathering and recurring themes and variables. Two recurring platforms were raised in terms of ICT access: mobile and Internet. Based on the preliminary survey results, data showed that in terms of affordability, these consumers are able to afford more information coming from mobile technology and Internet. In terms of information services, they invest too much on transport cost than service feature. In terms of willingness to pay, they are willing to pay around PhP7. Majority have difficulty in availing healthcare services and the finding of employment but the primary issue is not in terms of inaccessibility directly but more in terms of actual cost of goods due to lack of employment. 77% attribute their difficulty towards the cost of availing of these goods and services. The recurring themes that came up were: 1) sustainable transportation related to sustainable targets and sustainable legislation for transportation and land coordination policies/ designs, inter and intra- agency collaboration approach, agency prioritization and allocation process; 2) Energy efficiency, probably because of increasing oil prices and environmental health consideration.
  • 10.
    Ms. Susan Zielienski,Managing Director of the SMART Center University of Michigan gave an overview of the SMART program and shared some of the new mobility initiatives of the University of Michigan. She encouraged everyone to think of accessibility (meeting needs) rather than mobility as the goal to open up a range of new options for innovation, including IT. She highlighted that we all live in a world where transportation is equated to cars hence, improving transportation means improving cars. People are culturally connected to their cars that everything else becomes extraneous. People assume that transportation is necessary, that cars are necessary, therefore to improve on transportation, we must improve on cars. She asserted that life would be much better if we have more choices and not just simply choose to have a car.
  • 11.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 I. Welcome Remarks Dr. Antonio La Viña, Dean, Ateneo School of Government The project launch of Catalyzing New Mobility in Cities in Metro Manila held in the Social Development Complex Auditorium inside Ateneo de Manila University started at around 9:00 a.m. with Ms. Marie Cddyqa Jaya Rogel of the Ateneo School of Government (ASoG) leading the Invocation and National Anthem. She welcomed the various participants representing different transport organizations in the event. She then called Dr. Antonio La Viña, Dean of the ASoG, to give the welcome remarks. Dean La Viña welcomed the participants (See Annex A for list of participants) to the event and to the Ateneo de Manila University campus. He said that most of the things he had to say could be found in his column entry at The Manila Standard entitled New Mobility and Moving Metro Manila. He felt that moving Metro Manila was probably more important or equally important than what the country was facing in the judicial arena1 at that time. In his column article New Mobility, (See Annex B) he said that dealing with transportation in Metro Manila and getting it right is important for prosperity and in dealing with poverty. A mapping activity that aims to bring together stakeholders to the table and have a real good conversation about options with respect to transportation and a goal of making the people more mobile can be a good start. Making sure that the poor are not excluded in these conversations and decisions are also valuable in dealing with poverty. He ended by wishing everyone a fruitful discussion and a good day. II. Overview of the Innovations at the Base of the Pyramid in Southeast Asia Program (iBoP Asia) Dr. Segundo Joaquin Romero, Director, iBoP Asia Program Ms. Rogel introduced Dr. Segundo Joaquin Romero to present the iBoP Asia Program of the ASoG. (See Annex C for his presentation slides) Dr. Romero started by defining the base of the pyramid that started the iBoP concept. In his presentation of the world economic pyramid, base of the pyramid (BoP) was defined as people with annual per capita income of less than US $1,500.00. The iBoP uses the word “base” rather than “bottom” to refer to these people because bottom sounds too starved. He presented various data that further illustrates the base of the pyramid. The iBoP puts emphasis on their belief that low income does not mean no income and 1 Impeachment trial of Supreme Court Chief Justice Renato Corona 1
  • 12.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 suggests a range of opportunities for market-based approaches to better meet their needs and empower their entry into the formal economy. What the iBoP is trying to do is to come up with a business model - similar to the New Mobility Project- that focuses on the use of public social enterprises to cater to the need of the poor and the vulnerable. The program started in 2007 with Dean La Viña spearheading the unique way of putting together various disciplines and deploys them to engage BoP communities. The program’s stakeholders include the government, private sector, non- government and international sectors that work to engage the BoP sector in Southeast Asia (SEA). ASoG houses the program and has existing partner universities in Thailand, Indonesia and Vietnam and now plans to move to Cambodia as well. SEA countries are very dynamic moving towards greater innovation. However, iBoP is concerned that the innovation policies in SEA is more focused on economic and industrial development and less on poverty alleviation. European countries used serve as great models for innovation but increasing innovation capacity in Thailand, Singapore and Malaysia are now being aspired by other with transport being one of the major needs of the people. The iBoP currently pursues a two-track program or two major projects, the Universities and Councils in Innovations for Inclusive Development in SEA and New Mobility in Metro Manila. Dr. Romero also said that while the program is already three years old, its people are new so relatively, iBoP is a new program with new people. He also shared their early insights on innovation starting with a story of a Los Baños farmer during Masagana ’99. This farmer was able to produce 100 kabans per hectare through innovation but soon as he got his harvest, everyone went to ask for a share of his yield. Incidentally, he had to continue giving even when he was at a lost. The following year this farmer said no to innovation. He also shared another story that happened to their conversation with the community at Purok Centro. At the end of the workshop, the people raised two concerns: 1) that they were being census and may be asked to move out from their place; and 2) the project might lead to improvements that might attract informal settlers from other areas. These two experiences on the ground made them realize that the community is afraid of progress and that the burden of understanding is with the project people and not that of those in the BoP. Second insight was that universities are not geared toward the promotion of innovation because they are too divided into multi-disciplinary silos thus, could not fuse themselves together. Dr. Romero encouraged everyone to participate in what ASoG is currently doing and deploy together to promote innovation. He emphasized that iBoP is about mind shift, not improve BoP directly but help create a mind shift in the government and NGO sector. 2
  • 13.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 III. Presentation of iBoP Asia’s Key Projects A. Universities and Councils Network on Innovation for Inclusive Development in Southeast Asia (UNID-SEA) Ms. Mary Grace Santos, Project Manager, UNIID-SEA Ms. Mary Grace Santos was introduced next to present the UNIID-SEA project of iBoP Asia. (See Annex D) It is a partnership project between the National Research Council of the Philippines and Canada International Research Center. To put the project in context, Ms. Santos said that SEA experiences show spectacular growth in poverty reduction over the last three decades; however there is a big trade off for this development as inequality is also rising. She also mentioned that the Philippines have the highest gini coefficient2 in SEA. She said that we are in the field of innovation where innovation is defined as the development of technology, products and systems that aim at making things easier and improve the standard of living. But in reality, innovation process tends to exclude the poor and the social challenges they face in the innovation targets, which further exacerbates poverty and inequality. Social justice, equality and human rights are not deeply embedded in innovation found in SEA. These innovations are mostly economic and industrial in nature. Human development are not really used or prioritized so social development is just secondary to economic, technological and industrial development in innovation policies. iBoP with UNIID-SEA advocates for a new perspective on innovation and development through IID. IID is understood as innovation that reduces poverty and enables many groups of people especially the poor and vulnerable to participate in decision making, create and actualize opportunities and share the benefits of development. In a nutshell, it is like democratizing development with innovation being knowledge and skill driven; the project will engage the key agents that facilitate the production, diffusion and application of knowledge for innovation in various fields: universities and research councils. It is innovation for all and by all. UNIID-SEA is a 3-year initiative (2012-2015). The idea was conceived by iBoP Asia of ASoG and IDRC to first facilitate universities and research councils’ reinvention. Reinvention means to rethink, reorient, and retool to be capable intermediaries of innovation. For Universities, it is in teaching, research and extension and for research councils it is in priority/ agenda–setting, grant making with different minds coming together, and policy making. Second, the project seeks to facilitate the establishment of formal partnership and collaboration between universities and councils, which seeks to foster innovation research to reform social policy. Thirdly, the project aims to develop champions and nurture partnerships by 2 Standard measure of equality in the world. Gini Coefficient: 0 representing perfect equality and 1 representing maximum inequality. Gini coefficients of SEA -- Singapore: 42.5; Philippines: 44; Vietnam: 34.4; Malaysia: 37.9; Indonesia: 34.3 (Source: Securing the Present, Sharing the Future: World Bank East Asia and Pacific Economic Update 2011) 3
  • 14.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 forming a network and eventually connect to a global movement namely: UNIID South Africa, Latin America and South Asia. In the long term, the project aspires to foster multi-disciplinary, multi-stakeholder and multi-level (national, regional and global) approaches, mechanisms and partnerships towards IID. The project will be working with one university each from Thailand, Indonesia and Vietnam with ASoG being the lead university and project implementer in the Philippines, in partnership with corresponding research councils for the next three years. Ms. Santos also presented a quick run through of the activities the project will go through or its components: a. Knowledge and capacity building (multi-disciplinary course module, Social Innovation Lab, capacity building workshop for champions); b. Research support; c. Link to policy; and d. Network building She invited everyone to the project launching this Aprilthat will bring in representatives from all universities and councils ASoG will be working with. In the end, she encouraged everyone to engage and participate as they develop the project. B. Catalyzing New Mobility in Cities Project: Finding New Mobility in Metro Manila Dr. Marie Danielle Guillen, Manager, Catalyzing New Mobility in Cities Project Dr. Guillen was called to present the new project being launched on that day. (See Annex E) She started with the background and purpose of the project, which focuses on the use of new mobility as a lens in search of more sustainable and innovative solutions in the urban public transport system in Metro Manila, in particular, ensuring that the needs of the poor and vulnerable are met. Wanting to engage the participants, she asked them what they meant by mobility and how each managed to get to the event that day. Then she went through defining the concepts involved: Mobility – both the ability of a person (including the goods that the community needs) to travel to destinations of choice and the amount of movement and time necessary to do so. Transportation – the movement of people, animals and goods from one location to another. The field is divided into infrastructure, vehicle and operations. New mobility in this project refers to an initiative that is multi-disciplinary, multi-sector, top-bottom, bottom-up approaches like social enterprise innovations in mobility addressing a socially inclusive transport sector. Multi-disciplinary means that everyone is part of the transportation sector. She then recounted a story 10 years ago when she met a Japanese who inspired her to write a thesis on pedicabs while her friend worked on cycling attitudes in the University of the Philippines. 4
  • 15.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 This meeting led to an understanding on the attitude to cycle. Basically the study shows that built it and they will come. She highlighted that it took UP 7 years for the system to have a car-free oval an infrastructure that would promote cycling. This New Mobility project is looking at improving the transport sector. It tries to incorporate the dimension of sustainability in transportation such as social equity, economic, financial, health, ecology, physical environment, air quality, noise and climate change and not just focusing on traffic. This is based on the premise that as complexity increases, the notion that a single solution to solve transportation challenge also decreases and the need to look at the big picture. So there is a need for everyone to be engaged in the call for new mobility and be catalyst, try to find ways to solve these issues. Dr. Guillen then moved into differentiating some stakeholders involved in the New Mobility project such as engineers, urban planners and IT developers. She mentioned that everyone seems to do something to address the transport issues but are not linked. There is a need to connect the dots and find out how each can link together. The project aims to develop a new platform, resource center and enabler of innovation for purposes of governance ensuring socially inclusive mobility in the region. It also seeks to utilize and complement existing studies by initiating a metro- wide conversation among stakeholders to introduce new mobility and find out how the stakeholders envision the future of transport system in Metro Manila. Finding New Mobility in Metro Manila essentially means taking myriad steps that leads to a paradigm shift by:  Looking at the big picture;  Focusing on people’s needs and wants especially that of the urban poor and the vulnerable groups; and  Evolution of transport as attention turned to energy efficient mobility models, shared transport schemes and community owned transport. The project holds the Finding New Mobility Forum series called Let’s Talk New Mobility. These series serves as a venue for people to habitually share information, ideas, insights, and initiatives for taking action at a community level and increase advocates for mobility and access to transportation in Metro Manila. She informed everyone that a similar forum was held last October 2011 hosted by Ayala. She also shared that they conducted validation workshops with the urban poor community including tricycle operators and drivers association (TODA) to introduce the concept of New Mobility and noticed that people got a bit worried but eventually relaxed when they learned that this initiative is meant to focus on the people She further shared that when they went on field, the community representatives shared that they have no problem with road expansion but they were afraid that the New Mobility project would dislocate them from their home. This misconception about the project was corrected and the importance of road sharing for people as a way of fixing things was emphasized. The goal of this forum series is to sustain a conversation among these stakeholders on how citizens can be empowered to shape the patterns of mobility and access in Metro Manila to be more inclusive. An overriding aim is to promote other forms of public transport such as biking and walking. These forum series want to highlight the fact that government is doing its best to improve our transportation system and everyone needs a paradigm shift. She 5
  • 16.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 mentioned that in our country people often use cars as incentive as we move up the economic ladder but in other countries they use public transport as incentive. The project has a research aspect that seeks to explore how the current public transport system affects the poor and the vulnerable populations of Metro Manila by mapping the current public transport system and understanding the mobility patterns, cost and issues of the poor and the vulnerable groups. Aside from learning all the issues, seeking new or emerging entrepreneurial or livelihood opportunities responsive to their mobility needs, Dr. Guillen reminded everyone that they do have a role to play. New Mobility also seeks to engage the general public. This activity aims to build a community of people wanting to create a platform or build on available platform to improve information generated in maps for seamless multi-modal connections. This is expected to benefit not only the poor and the vulnerable groups but the general public as well. The development of a mapping concept is needed to see the connectivity. The project also has the search for New Mobility Business Models: New Mobility Social Enterprise and Social Innovations Award, which has the following objectives:  To surface enterprising solutions to solve social mobility problems;  To engage different stakeholders in solving pressing mobility problems in the megacity especially that of the poor and the vulnerable sector; and  To document existing social enterprises in the transport sector and generate innovative ideas that address mobility problems and needs. Then as prelude to the next speaker, Dr. Guillen said that the project basically attempts to generate inquiries, present more information, tickle the interest, insights of the people, initiatives, innovations and interconnections. IV. iBoP Asia Website: iFind New Mobility Mr. Andre Quintos, Web and Networking Coordinator, iBoP Asia Mr. Quintos presented the iBoP Asia website (www.ibopasia.net) most specifically the new mobility section named iFind New Mobility. He started identifying the sections of the iBoP website home page with the header being a photo that illustrates the problem on new mobility. He said that the purpose of the New Mobility page on the site is to be a portal for everything related to new mobility. In the site you can find local and international content containing articles, blog posts and links to other websites. When users visit the website, they could immediately see the scope of what the website covers. iFind New Mobility is a blog where you can find anything related to new mobility. Latest news on new mobility can be found there. The sidebar on the right has links to other websites that help a typical commuter get around the metro, i.e. commuting in Metro Manila, MMDA, Metro Manila direction and ParaSaTabi.com. These links 6
  • 17.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 can help commuters go from one place to another. The news and information page talks about the new mobility project and other project related events. Project Activity page would describe the activities of the project and explain what is happening. The Events page contains anything that happened in the past and has yet to happen. Mr. Quintos reported that he is working on a twitter feed to promote all the articles found in the website to the social networking site Twitter. Videos would be uploaded also on the New Mobility Watch page. The picture galleries of past events could also be found in the site, for example, the team’s recent visit to GK Village in Payatas. He informed everyone that the existing site is just the beginning and that data are being collected and placed online. He envisions the site to be more useful to people in the future by including a transportation map in real time using available open applications. He shared their plan of adding New Mobility Marketplace where people can post anything transport related they want to sell such as transport for sale, biofuel etc. Another possibility is to have a contest to get everyone engaged and hopefully help people learn about new mobility. V. Mapping for Inclusive Mobility: Pinpointing Transport Terminals and Hubs Mr. Lorenzo Cordova, Jr. Research Associate, iBoP Asia In order to understand mobility, Mr. Cordova deemed it necessary for all to look at three things: 1) the different modes of transportation 2) the factors affecting public transport and 3) planning and advocacy. (See Annex F) From a perspective of a commuter, he presented the need to pinpoint the public transportation terminals and hubs and their connection using a map to increase mobility. The following were the key concepts of his presentation:  Modes of public transport  Public transport (PT) hubs  PT terminals  Informal transport hubs/terminals  Engaging stakeholders in mapping He started by showing photos of the diverse modes of public transportation and said that each plays a major role in mobility especially of the poor and can either compete or play a complementary role to other forms of PT. He showed more photos of public transport hubs and multi-modal transport terminal in Metro Manila. Photos of PT terminals, mostly found in secondary roads, were also shown. Informal PT terminals/ hubs were defined as areas that are public or privately owned, used by motorized and non-motorized PT vehicles as terminals, but have no clear legal 7
  • 18.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 provision and/or local government ordinances that support its existence. However, in reality, these informal PT terminals are often the source of living for the poor and vulnerable. Why is it necessary to pinpoint PT terminals and hubs? One reason presented by Mr. Cordova was the complexity and diversity transportation modes. Second is the growing number of unaccounted PT terminals and hubs that hinders the walkability and sometimes obstruct the flow of transport. Third, its existence is not a secret but the country lacks readily available and accessible information where they are. Fourth, LGUs and other government agencies lack capability to produce up-to-date map and last but not the least, mapping requires much time and resources. In commuting in Metro Manila, do we think of connection points? What are our choices and are they efficient? These questions were presented as the rationale why we need to map transport terminals and hubs in Metro Manila. They are crucial in order to assess the mobility problems and opportunities in Metro Manila and to improve information generated in maps for seamless multi-modal interconnections that would benefit not only the poor and the vulnerable groups but the general public as well. The goal of mapping was to build a community of people wanting to create that platform or build on available platform. He showed a mapping example of something they did in his GIS class to map the tricycle terminals in Barangay Bagong Silang, Caloocan City. The violet dots, representing the terminals, were all over the map (see Annex F, slide number 10). According to the local tricycle regulatory unit in Caloocan, they said that the there should be at least one terminal per one TODA but the map showed many tricycle terminals located near each other. In his study, he found out that too much transportation terminals and supply causes too much violence in the barangay. The second map he showed (see Annex F, slide number 11) illustrates that most of the terminals use up space for pedestrians and sidewalks thus reduces the walkability of the barangay. This situation is not unique in Bagong Silang and can be found anywhere in Metro Manila, thus the need for proper mobility mapping. Mapping for inclusive mobility needs three major components:  Individuals and organizations as contributors  Intermediation platform – “enabler”  Users Mobility mapping can either be done using “hi-tech” or “hi-touch” methods. Hi- tech uses available open platform from the internet like google map or open street, while hi-touch will be the one used on the New Mobility mapping workshop using the University of Michigan-SMART Centre approach the following day. Hi-touch method involves seven or more people in a group mapping and noting connections and locations of specific terminals. He showed a listing of several existing web-based platforms that can be utilized to map the terminals. Possible information from stakeholders would include:  Mode of public transport  Location of terminal/ hub  Name of TODA, JODA, PODA etc.  Number of members 8
  • 19.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012  Destinations/ routes  Time of operation  Facilities and services available in the terminals/ hubs He gave a quick conceptual framework of how the project intends to map mobility. They wanted to form a community; utilize different platforms such as the Internet, mobile and hi-touch method; map out applications; and validate and hopefully be published online as a resource for the mobility of community. The project aims to improve the quality of information through a collaborative process, increase awareness among stakeholders, expand useful data available data for decision makers while enabling much broader spectrum of citizens to actively participate in citizen science in their own communities and to contribute their collective opinions and decisions. Hopefully the “hi-touch” method would increase efficiency to the generation of data and reduce costs. Generally, the project aims to empower a community of people that want to create or build on existing platforms. The community of empowered people will be producing data at the same time consuming them hence naming them “Prosumers”. He informed everyone present that the maps generated will be made available on- line as a community resource and should be able to generate discussion among stakeholders to improve state and improvement of the transport system in Metro Manila. He reminded everyone that mapping is an evolving activity so new approaches may become available over time. Finally, he said that everyone is welcome to give suggestions on how to improve their project. VI. Search for New Mobility Business Models in Metro Manila Ms. Jessica Dator-Bercilla, Senior Research Associate, iBoP Asia Ms. Dator-Bercilla started by asking who among the participants have tried walking and using public transport. She then asked whether the people from the audience ever thought that this experience of walking and/or using public transport would get better. She asked the audience whether any of them have written down or implemented their dream. She noted that many Filipinos lost the capacity to experiment and innovate soon after colonization. The psychology of Filipinos noted that Filipinos are too used to borrowing ideas or solutions from others (countries) that we forget to dream enough to experiment. But under the New Mobility project, this notion would be dissolved. A new business model search would be made open to all for their transport dreams to turn into reality. First she presented was the Social Innovation Initiative/ Concept Awards. (See Annex G) This opportunity is for those who have not written their idea on how to make urban centers more mobile. The project will accept concept, ideas and solutions specifically addressing mobility problems in Metro Manila. Essentially this is a solution-seeking initiative. The project is looking for innovative ideas under these four categories borrowed from the 4Ps of Innovation by John Besseant and Joe Tidd of the Humanitarian Fund: 9
  • 20.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 1. Product Innovation – new mode of transport 2. Process innovation –new way of being mobile 3. Position innovation –new form of mobility 4. Paradigm innovation The next was the Best New Mobility Social Enterprise Award. In searching for a new business model, the project team decided to focus on social enterprise specifically for the transport sector that address new mobility problems especially that of the poor and vulnerable. Entries must reflect sound management, should be properly documented and reflect a social enterprise (SE) that meets multiple bottom lines. SE uniquely uses the capabilities of different stakeholders as leverage to deliver goods and services in the area of mobility to meet multiple bottom lines. It can target the following or even more bottom lines:  Surplus or profit generation, where profit is reinvested for the gain of the stakeholders and further pursuing the social objective  Environmental health  Preservation of cultural integrity and diversity  Capacity development or empowerment of a sector or community simultaneously improving their quality of life.  Climate change Below were examples of probable entries around the globe Ms. Dator-Bercilla presented:  Cargo bike of Worldbike  Mini-Bus Operation, Day Care Transport, Special Education Needs Transport by the HCT Group in UK.  Agency Community transport Model and Transport Asset Management Riders for health  Non-emergency Medical transport by Tranmedic  Mobility Scooter by Rugged Tree She also mentioned that the entries should be existing projects meeting the following common criteria:  Clear identification of mobility issues being addressed especially with those of the urban poor and vulnerable groups;  Employ approaches that incorporate principles of sustainability in transportation that address issues in ecology, social equity, health, finance and economy, air quality, noise, climate; and  Clear identification of challenges being addressed and of success indicators Lastly, she presented the schedule. After the project is launched, formal calls for nomination would be open at mid February and run through March 2012. A Committee deliberation follows around April-May 2012 and the winners can be nominated to present at the Rio Entrepreneurship Summit in May –June 2012. Before she left, she directed questions to Dr. Guillen. 10
  • 21.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 VII. Sharing the New Mobility Agenda A. Search for New Mobility Opportunities in the AdMU Fr. Jose Ramon Villarin, S.J., President, Ateneo de Manila University When the forum resumed after launch, Ms. Rogel introduced Fr. Villarin to share his thoughts on the new mobility opportunities in AdMU. He happily recalled the time when he used to walk from Dela Strada Church, 2 km away, to Ateneo in high school. The school did not have too many buildings then in 1970s and walking is something that the people like doing. But now as the school President for 18,000 students, the Challenge is making Ateneo a sustainably mobile campus. He shared that there are plans for pedestrianizing the campus. Currently, there are around 2,000 cars that park inside the campus and occupy 7.5 hectares of prime real estate and cost several billion pesos. What he sees and hopes for the campus is for it to become a carless campus. He looks forward to the New Mobility project because aside from helping others and the city, which he grew up in and learned to love, the project will also help the campus. He also hopes that the innovative ideas would not simply be shelved and be replicated and adopted by other campuses in the country. He shared that majority of the ideas will depend on how lands are allocated. Before he left, he welcomed everyone to the campus and wished for the project to succeed. He also emphasized that AdMU, contrary to what is perceived by many, is not an elitist school. He proudly claimed that they form their students to look beyond the campus and include the marginalized people. B. New Mobility Initiatives of the MMDA Hon. Francis Tolentino, Chair, MMDA Chairman Tolentino started with a photo from the Balikatan exercise, a general being carried on the back of another man. He said that this photo illustrates the situation of transport mobility in our country where people are indolent walkers. More than the concept of pedestrianization, he deemed it necessary to find out why there is a need to motorize. He expressed his thought that this project should also look into why Filipinos are not pedestrian citizens. He then moved to presenting the new mobility initiatives of the MMDA. He announced a proposed skybridge project that would utilize esteros to address hopefully address mobility issues. He hopes that this would open the minds of urban planners, policy makers, local legislators and city 11
  • 22.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 engineers that it is about time they utilize esteros for transport purposes. He proposed a shift in outlook for esteros as source of crimes, disease, flood, urban decay etc. He stressed the importance of esteros to renew Metro Manila similar to Seoul, Korea; Bangkok, Thailand and Macau. He said that they intended to publicize the Skybridge project in the next weeks. For the New Mobility initiative, he agreed that everyone must free himself or herself from the tendency to see Metro Manila as roads and bridges and see that it is made of human beings. He found it very appropriate to include the poor and marginalized sectors in the project. He then moved to presenting the following future and current projects of MMDA (See Annex H): 1. Plan to have bicycle lanes from Remedios Circle to Intramuros 2. Construction of pedestrian-friendly footbridges: These footbridges aim to avoid conflict between motor vehicles and pedestrians by providing safe movement at intersections in selected locations. Instead of using the usual road or pedestrian lane, the MMDA created footbridges as an alternative and safer way to go to the other side of the road. The MMDA will be taking the design and construction of footbridges in a whole new level. The new design to be constructed in Sucat and funded by the DPWH, will include man-lifts, which can accommodate up to six persons in any given time. With this design, persons with disabilities (PWD) will be able to traverse the other side of the road safely and more conveniently. 3. Elevated loading and unloading bus bays: The bays aim to eliminate the practice of indiscriminate embarking and disembarking of bus passengers in non-designated areas. The agency is proposing to implement the elevated loading and unloading bays, similar to what is being implemented in Jakarta, Indonesia. Bus bay will have an elevated platform approximately one meter from the carriageways. Likewise, bus floors will be customized to align with the boarding platform. Bus bays will be modified to ensure the convenience and safety of passengers by providing roofs, seats and proper ventilation, among others. Ramps will also be provided for the elderly and the PWDs. There is now a Land Transportation Franchising and Regulatory Board (LTFRB) resolution signed regarding this so Chairman Tolentino was certain that this would be implemented. Hand in hand with this initiative is MMDA’s push for bus drivers to receive fixed salaries to prevent them from hoarding passengers. A single ticketing system of traffic violations across Metro Manila which aims for a centralized database of traffic violations is also expected to run by March. 4. Motorcycle lanes: For Chairman Tolentino, this is the best indication that Filipino drivers can be disciplined. Motorcycles have steadily proliferated in the metropolis and they contribute to traffic congestion. Given the limited training of motorcycle drivers at the onset, they can endanger road users’ safety. In response, MMDA designated non-exclusive motorcycle lanes or “blue lanes” along Commonwealth Avenue in Quezon City (QC) and Macapagal Avenue in Pasay City. This will be expanded to include EDSA starting February 14, 2012. Since its implementation in Commonwealth and Macapagal Avenue, there was a significant reduction of accidents in the mentioned thoroughfares. Chairman Tolentino hopes that this will pave way 12
  • 23.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 for bicycle lanes, and that with the right infrastructure, support and mindset, this can be accomplished. 5. LED Message Board: MMDA will be installing light emitting diodes message boards in major roads in Metro Manila to provide traffic advisories as well as road safety reminders to guide road users. An example of this is the led message advisory along EDSA Main Avenue, Southbound. 6. Mega Manila Provincial Integrated Bus Axis System: MMDA is embarking on The Mega Manila Provincial Integrated Bus Axis System (MM-PIBAS) which aims to improve traffic conditions by prohibiting provincial buses from plying the major thoroughfares of Metro Manila, minimizing public bus transport congestion, eliminating vehicle-pedestrian conflict and promoting faster mobility. This will be done by providing central terminals in the north, east, south and southeast for provincial buses coming from those corridors. The MM-PIBAS shall be patterned from existing centralized bus terminals in other countries. Looking at airports as models, the MM-PIBAS is envisioned to be a terminal building complex with large area to accommodate many buses, park and ride facilities, dedicated space, which allows the mobility of passengers and convenience of cargoes and suitable location accessible to other modes of transportation. The idea is to consolidate the 85 existing provincial bus terminals with 60 bus companies operating approximately 7,368 buses into 4 common terminals (North, East, South and South East). Chair Tolentino announced that President Aquino will be releasing an Executive Order in February directing MMDA and DOTC to start working on this. Hence, Chairman Tolentino’s quick trip to Seoul the following day with DOTC officials to specifically look at the operation of their bus terminals. He strongly believed that this would be President Aquino’s pet project so it is likely that this would be operational at the end of the year. 7. Vehicle Tagging: MMDA’s vehicle tagging scheme involves the permanent painting of license plate details of public utility vehicles (PUVS) on all sides of the vehicle and roof. Each type of PUV has a distinct colored background with prescribed measurements for the text and background. This was partially implemented on city buses starting last August 15 and on AUVs on December 12 last year. The scheme has helped in tracking and apprehending vehicles that have committed traffic offenses and city buses operating outside of their franchised routes. It has also diminished the unlawful practice of bus operators swapping plate numbers and the number of hit- and-run incidents committed by reckless bus drivers. This initiative came from the transport sector. This is part of the government’s public private partnership and has no cost to the government. 8. Metro Manila Traffic Navigator: A major public-private partnership initiative of MMDA in coordination with TV 5. An online media service providing updated traffic situations in 9 major thoroughfares, EDSA included. Using this system, passengers and motorists are being empowered to make well- informed decisions taking alternative/less-congested routes. This service can be accessed by any web browser-enabled device at http://mmdatraffic.interaksyon.com and may be downloaded to smartphones and tablets for free. The TV 5-MMDA traffic navigator was awarded the bronze Boomerang award for innovation by the Internet and Mobile Marketing Association of the Philippines (IMMAP) last August 18, 2011 and 13
  • 24.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 the I.T. award of the year. This award symbolizes the power of combining technology and public service to bring real positive change. Chairman Tolentino wanted to ask the developers to make the program more visual and include intersections at real time. 9. EDSA makeover project: MMDA is partnering with the private sector in transforming EDSA into a traffic discipline zone, making it a motorist/ commuter and pedestrian–friendly thoroughfare. Other components of this activity are landscaping and greening, beautification, installation of adequate lighting along EDSA using energy efficient light emitting diodes (LED) technology especially on sidewalks, tunnels and footbridges to avoid proliferation of bad elements and installation of CCTVs, upgrading of street signs and maintenance of foot bridges. MMDA is looking at Mongkok and Suanlum in Bangkok as models. 10. Estero Bridge Part II: This is an activity that aims to clean two esteros at a day. MMDA said this is challenging not because of the amount of trash but because of the people who want to be relocated. These people do not want to live in the estero de Concordia example. MMDA’s difficulty was how to transfer the people when government resources are limited. Chairman Tolentino called for everyone to change the way they look at cities as not just buildings but with people. Also change their perspective on esteros as areas of opportunities and harness the talents of the people living there. In the same manner, he called for people to look at transport in Metro Manila. At the end, he said he is looking forward to the results of the studies commissioned by the project to improve Metro Manila transport not just this year but in the years to come. C. Responding to New Mobility Challenges of Quezon City Retired Brig. Gen. Elmo San Diego, Head, Department of Public Order and Safety Quezon City General San Diego reported that Quezon City is one of the biggest cities that occupies 1/4th of Metro Manila. It has a population of 3 million with half belonging to the poor. QC is also one of the richest cities throughout the country and the richest in Metro Manila based on the latest COA report. With such characteristics, it attracts business investors and also informal settlements. The biggest challenge for the city is the increasing number of informal vendors and how to eliminate them. QC’s response to mobility challenges is how to coordinate with other agencies to support their programs. General San Diego also shared project Open Katipunan (OK) that they planned to implement with Ateneo. The Ateneo community consists of grade school and high school parents, students and student council members who meet every month to discuss traffic and other problems along Katipunan. Ultimately, the goal of project OK is to reduce cars traversing along Katipunan by 50% 14
  • 25.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 Then he moved on to share their latest mobility program, the electric tricycles. (See Annex I) To set the context, he said that tricycles are the most preferred and most convenient motor vehicle used by the marginalized sector in QC. At the onset, e-trike was a traffic initiative that reduces carbon emission within the campus but the students wanted it to ply along Katipunan. The City Council deemed it dangerous but they supported the idea nonetheless. In partnership with the Department of Energy (DOE), QC was chosen as a pilot area to run e-trikes under the generous funding of Asian Development Bank (ADB). The bank allotted US$ 40 Million for 32,000 e-tricycle units. It is a rent-to-own nationwide program designed jointly by LGUs, DOE, ADB and government financing. The basic requirement is to trade conventional tricycle with e-trikes. General San Diego showed photo samples of e-trikes that are actually used in different parts of the Philippines like Palawan and Mandaluyong. He mentioned that the initial design of the e-trike in QC failed because the units were underpowered and could not handle the slopes of Payatas. QC was chosen as a pilot area because they have the most number of registered tricycles with 5,000 plying as “colorum”. In this regard, QC issued a moratorium in tricycle registration because of the number of unregistered units plying the road. There were several changes proposed for QC’s e-trike program. This includes the following: 1) The use of Lithium-ion battery rather than lead. Lithium-ion is lightweight; its lifetime is more than 5 years, and saves space inside the unit. 2) The construction of several charging stations all over QC. 3) The use of a more powerful engine that can run the slopes of Payatas. 4) The use of a fiberglass body to endure harsh weather conditions. He also presented advantages in using e-trikes which include the following: 1) Fuel savings of about P200 from the regular income of drivers and estimated US$ 185 million per year. 2) Aboost in the manufacturing industry since all parts are made locally. Manufacturers intended to participate in the bidding of ADB. 3) An advocacy for cleaner air by avoiding carbon emissions that amounts to 400,000 tons per year. 4) Helping in the development of cities outside Metro Manila by donating retrofitted conventional tricycle units that would be traded in for e-trikes. 5) A bigger potential income for drivers since they save on buying fuel. Also part of the proposal made with DOE and ADB is the gradual phase out of petrol-fed tricycles. This would entail provision of incentives such as preferential franchise or route for e-trike users and/or exemption from number coding scheme. The city government is also gearing up for e-trike related business. The project hopes to complete e-trike units delivered to LGUs with a standard 3- year warrantee. For QC, they will start distributing 2,000 units this year and 5,000 every year until 2016 for a total of 22,000 e-trike units. By 2016, ADB expects to complete the distribution and operation of 100,000 e-trikes throughout Metro Manila, QC included. Several provinces in the north like Cabanatuan, Palawan, Davao, and Mindanao are also beneficiaries of the ADB program. 15
  • 26.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 The program is running in Mandaluyong already. General San Diego showed data on the management and operation of their e-trikes and the result was quite encouraging. He showed a simple comparison between a standard trike and e-trike in terms of fuel savings, economic savings etc. E-trike costs more than a standard tricycle (P200,000) because of its battery but when it comes to road space, 2 conventional trikes = 1 e-trike. E-trike also carries 6-8 people while conventional carries only 3-4. Gross income of drivers on a daily basis amounts to P800 for a conventional tricycle and P1,600 for an e-trike. D. SMART Program and New Mobility Initiatives of the University of Michigan Ms. Susan Zielenski, Managing Director, SMART Center University of Michigan Ms. Zielinski informed the audience that the New Mobility project of iBoP Asia is a sister study in SMART Centre also which also got itssupport from the Rockefeller Foundation. They share the same sister community in catalyzing new mobility in cities. She explained that the following day, participants would experience SMART mapping. The three things the new mobility project aspires are:  Connecting the dots: For livability, sustainability, equity  Moving money: Innovation, access, jobs, enterprises  Moving minds: New way of looking at transport and cities. She presented existing labs in the different parts of the world and their partners and sponsors. (See Annex J) She posed a question: “Why did the chicken cross the road?” and got diverse answers from the audience. But she said chickens do cross the road for the sake of moving. They do it in order to go to the other side of the road. She encouraged everyone to think of accessibility (meeting needs) rather than mobility as the goal to open up a range of new options for innovation, including IT. For example, making trips shorter and more efficient through IT enhanced integrated mobility, but also through eliminating trips through IT enhanced land use and urban design, and even more immediate, replacing trips altogether with IT such as tele-work, tele-shopping, tele-banking, tele-education etc. Mobility is not only about moving people. Mobility is transportation capacity expansion, land use planning and travel demand management. We all live in a world where transportation is equated to cars hence, improving transportation means improving cars. She noted that people are culturally connected to their cars that everything else becomes extraneous. She presented words that describe this connection: “captive” and “transportation disadvantaged” where captive means having no choice while transportation disadvantaged is when anyone who has no access to a car becomes poor and because he/ she has to ride a bus. In this association, people assume that transportation is necessary. Therefore, cars are necessary; therefore to improve on transportation, we improve on cars and that is why car companies make car improvements a lot. She asserted that life would be much better if we have more choices and not just simply choose to have a car. She also dissected the words typically associated with transportation and mobility, which she felt, must be changed to something more exciting and true: 16
  • 27.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012  Captive – means forced  Transportation Disadvantaged  Alternative Modes– seems like the “alternative” will never make it. Sounds like second choice.  Public transport cost versus investment  Transportation demand management – sounds constraining and associated with sacrifice  Sidewalks - sounds not too prioritized as the they refer to the side of something  Road closing versus openings  Car use reduction versus more options She wanted everyone to transform the notion that transportation is flat. There are actually more connected choices in new mobility. This transformation of paradigm from monolithic to multi-faceted and connected is a foundation for a major emerging industry. The new paradigm she proposed was based on the tons of innovation going on around the world. Mobility is about moving people, moving goods and moving less. This is highly evident in the greater desire of young people these days with IT than cars thus, IT is not just about moving people but also about moving goods and moving less. She advised that when implementation seems difficult as to which should be done first, she told the audience to do it all at the same time. Then she commended the event because it gets people together. She emphasized the importance of connectivity and optimization of all kinds, which can be seen by mapping. In mapping, a new mobility grid can be revealed by identifying and overlaying everything. Implementation is like a human body system, a system that needs all parts, big and small to run. One would never ask which is better or force the choice between the heart, lungs and pituitary gland because they are all necessary. It goes the same for transportation. Focus must be given more on increasing, optimizing and enhancing the connectivity of the current options. In new mobility, there is huge economic activity, saving money, creating jobs, and revitalizing local economy. She ended with a hope that a lot of entries will come from the Philippines in the SMART Mobility enterPrize. This is an award for entrepreneurial ventures in sustainable transportation created by University of Michigan’s SMART initiative and with support from the Rockefeller Foundation. The entries should demonstrate innovative and replicable solutions to local and global transportation challenges, up and running, legal and can come from anywhere from the world. VIII. Open Forum After lunch, Ms. Rogel opened the floor to questions, comments and suggestions. The participants were requested to approach the microphones in the aisle, state their name and organization before speaking. QUESTIONS/ COMMENTS ANSWERS/ RESPONSES Concerns from Elvira Medina, President of National Center for Commuter Safety and Protection: a) On the use of e-tricycle. Electricity is 1) Engr. June Yasol, General Manager 17
  • 28.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 QUESTIONS/ COMMENTS ANSWERS/ RESPONSES still generated from fossil fuel and what of JAYAREC: The units are not about the horrendous electronic waste powered by lead acid but Lithium ion generated in using lead acid to operate battery. It has 3-year warranty and 5 the units? For her these should be years life cycle with performance addressed. tested to last 10 years. Indirect use of fossil fuel through charging as Mr. Bharat Bongu(Intellicap): compared to use of gasoline. Drivers could also earn more by saving money What are the costs 5-years down the on gasoline. line for e-trikes? 2) Benjie dela Peña: Personally not in favor of solutions that only look at technology but transport mobility needs all the help it can get. One thing that e-vehicles can do is it moves up the question of source of fuel higher up the chain. If you move it up higher the chain, it is easier to change the system. It does not matter with the driver the source of fuel as long as it gets its electricity. It is easier at the platform to change the source of power. b) Ms. Medina also commented on the Benjie dela Peña: The issues of the framing of the poor and vulnerable. The poor and vulnerable are not only use of the term poor and vulnerable about transportation. The expression versus use of general public. “Poor” is of what is poverty also changes from an economic condition while situation to situation. In the US there is “vulnerability” is a physical and social an infrastructure gap, people who live condition. The poor and vulnerable near mass transit lines can afford to should not be separated from the use cars and go to offices using their general public but be coiled into one car whereas poor have no access to term: “commuters”. In the BoP, the public transport stations thus they biggest sector is commuters. Many of need to buy cars but have no means to the poor are economically active but do so. The terms “poor” and have limited opportunities and they use “vulnerable” works well for the public transport. Quality of life revolves Rockefeller foundation. It caters to around the term “commuter”. particular interest of the issues of people who do not have adequate housing and opportunities in livelihood. Bert Fabian, CAI-Asia: Fully supports the forum but needs continuing discussion. There is great opportunity in the fact that President Aquino, MMDA Chairman Tolentino and AdMU President Fr. Villarin are former classmates to have these discussions. It looks like there is still an inconsistency 18
  • 29.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 QUESTIONS/ COMMENTS ANSWERS/ RESPONSES in the concept of mobility especially since most of the major projects are still centered on vehicles and not on people. Government can or must campaign for better public transport that is on time and convenient. But overall, he believes that it is high time to have this kind of discussion on new mobility so he emphasized that this organization CAI Asia commits to the project. Engr. June Yasol, General Manager of JAYAREC: When talking about catalyzing new Dr. Segundo Romero: In catalyzing mobility in cities, are you referring new mobility in cities the key word is more on RnD or is there application for mind shift. How do you break the grants (e.g. invest on e-trike pilot paradigm of the poor to somehow projects). There is a need to have solid accept the imposition of car owners to ground for mobility and not just ideas be on the same boat? The project does not aspire to give commuters a better transportation system but the project offers them up to the possibility of what can be done. Start with very small things like having a pool of knowledge and come up with a map on informal transport hubs to be shared to everyone. The project is trying to motivate the target beneficiaries to help themselves. Other countries already have maps available and if we do not start soon, our country might be left with bad handed down technology by our neighbors. It is a contest with them also in improving our transportation mobility faster than they do. In this regard, the New Mobility forum is targeted to happen every month with different stakeholders. Dr. Kardi Teknomo from Ateneo: One of the most important mode of Dr. Segundo Romero: This is where hi– transportation is walking especially for touch mapping effort might help. the poor. Unfortunately, most of the People looking at maps and identify innovations were more on vehicles sidewalks, blockages etc. opportunity, such as e-trike or e-jeep. Walking needs facilities that work and those that do no facilities but needs monitoring. The not. Once identified, what can be system of monitoring does not happen. done? Is there something for the Reporting and feedback from the barangay captain to do? What about 19
  • 30.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 QUESTIONS/ COMMENTS ANSWERS/ RESPONSES community is needed. the Head of the association? It becomes actionable because information becomes tangible. Bringing the action down to the barangay might yield quicker and better result than relying on government alone to take action. The proper mind shift is that it is not always the government or MMDA’s role. If the community can do something, they must act on it. Advocate for social accountability. Mr. Alberto Suansing, Executive Director of Philippine Global Road Safety Partnership - Philippines: Hope springs eternal. He mentioned Dr. Danielle Guillen: This project is not that various studies and talks about only RnD, it is about complementing transport and mobility exist but he was and reaching out. She told the story glad to have this forum to raise about TODAs not knowing where the problems and come up with solutions. other terminals are as a clear example These transportation mobility issues of the need to complement public had been talked about but problems transport service. The project aims to arise due to neglect. The Government introduce the idea of complementing was not really able to focus on public each other work to be efficient and transportation. He shared about have the connection. The project also dispatching nightmare in buses and his emphasized on IT and the promotion thoughts on how improving the salaries of transportation planning. It is a top- of bus drivers may not fly because the down and bottom-up initiative where current system is still weak. The talking with policy makers happens at operators in our country still focus on the same time as rounding up new their business and not public service. business models and innovative He believes that fare increase to cope solutions at the community level with fuel increase is not the answer to transport problems rather optimizing the use of roads. He also said that there is politics in terminals. Then he raised the issue on safety of commuters. Nevertheless, he was glad that mobility is now being looked into. There are so many solutions that can be applied. The good thing is that this project has social aspect. He expressed his skepticism on MMDA’s UVVRP, which will not work in the long run because it only increases the volume of vehicles. Most people buy another car just to avoid the UVVRP. The country has been compared to Singapore a lot but Singapore compared to the Philippines has a very respectable public transport system. 20
  • 31.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 QUESTIONS/ COMMENTS ANSWERS/ RESPONSES Karmi Palafox from Philippine Institute of Environmental Planner and Palafox Associates: Susan Zielinski: Traffic congestion and a) The drawback in some of the mobility are not different problems. mobility designs came from the The question is how do you send the way urban planners conceptualize right signal? What are we them. They think as if all are car communicating about? It is more users important or necessary to know what kind of city we want to live in rather b) Is there congestion charging in the than think of congestion etc. What project? kind of transportation combination? c) Framing of poor and vulnerable. If progress is desired, involve the private sector. However, are they willing to do things for the poor and vulnerable? She suggested not using words that may turn off the private sector in marketing. Dr. Hussein Lidasan, Transportation Science Society of the Philippines: Supports this activity and committed to help in any way they can. The ultimate goal is to minimize the movement of vehicles but not the movement of people. But it is not just about mobility per se but also access. Economic measure is the dream of every transport planner. Economic measure means, people who are willing to pay will pay higher but they will be expecting an efficient transport system. In terms of information, people appreciated and understand better visual explanations rather than numerical. The bottom line is to see what is doable. Look at how you can connect the people through the transport system. This forum was a start and hoped to continue and improve or alleviate the cancers of transportation. He wanted to hear how to improve quality of life without compromising the environment. IX. Updates/ Insights from the Rockefeller Foundation 21
  • 32.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 Mr. Benjamin dela Peña, Associate Director, Urban Development The Rockefeller Foundation Mr. dela Peña recounted his story or experience in walking and commuting in QC before. For him, he agrees to what Danielle said earlier, Metro Manila is transportation rich especially in the poor areas. However, there is a windshield bias by the policy makers and decision makers and people always see traffic as the main problem. His presentation centered on the seven needs of transportation (See Annex K): 1. Takes us where we want to go 2. It takes us when we want to go 3. It is a good use of our time 4. It is a good use of our money 5. It respects us with the level of safety, comfort, and amenity it provides 6. We can trust it 7. It gives us freedom to change our plans Sometimes a shift in paradigm involves a change in jargon like calling the Traffic Management Unit of MMDA to Transportation Management Unit. He emphasized connections as very important in transportation and the poor and vulnerable as the most affected. People who think about mass transit always think about speed. The experience in mass transit is speed is not as important as frequency. Emphasis was also given to transportation sharing or allowing people to walk. Some say Filipinos are lazy walkers but they do not realize that it is because facilities are not available for people to walk on. When it comes to transportation, cars are still the priority when it should be the people. A clear illustration are the steel barriers in EDSA preventing people from hitting cars, denying people to move in the way of cars. The good news is that the complications do not just happen in the Philippines. Other countries experience drawbacks so as they find solutions, the country can learn and we can share the experience. He said that there is hope starting with conversations. It is not fair to put it all in the hands of the government and believe that they will solve the problem. The government has to deal with electoral issue (the official’s terms) and budget cycle. However, the government should also have a clear vision and not just presenting solutions to problems. He ended with a quote by Jan Gehi from Making Cities for People: “To be a lively, attractive, safe and sustainable city, (a city) must be sweet to its pedestrians, sweet to its cyclists.” There is a movement of a shared longing. 22
  • 33.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 X. Understanding the Challenges and Opportunities in New Mobility A. How responsive is Metro Manila’s Public Transport System to the Needs of the Poor and Vulnerable Sectors? Insights from a Mobility Mapping Case Study of Metro Manila Dr. Jun Castro This is one of the three commissioned studies of iBoP about mapping. It tackles the question, how mapping can be used to respond to the needs of the poor and vulnerable. The study uses Geographic Information System (GIS) as tool similar to google earth. GIS has been used in a number of planning studies to organize large volume of information. There are limited studies in linking mapping, public transport and the poor/ vulnerable. The following are the research project goals (See Annex L):  Use of GIS, identify, map and assess PT supply (modes, routes and facilities)  Identify gaps in the data sets or barriers to access these data sets  Assess the mobility of the urban poor and vulnerable sector in relation to transport supply  Identify transport-related improvements in infra and services that will benefit urban poor communities in the case study areas This research will run until March 2012. It will use primary data collection, identify alternative mapping techniques, develop a database of public transport hubs and map out public transport networks. The expected output is a documentation of process for generating, encoding, storing, sharing and displaying user-friendly maps of public transport hubs/ terminals using a GIS database. The methodological framework starts with a review of data followed by database development where the team will be asking existing private database, use crowd-sourcing, field surveys and validation. Next is to do spatial analysis using GIS overlaying transportation and its relationship with informal settlements will come after. Last step will be publishing the result. In their initial review of data, they looked at some of the database of MMDA such as studies on informal settlements, which involve a map of informal settlers in Metro Manila. As part of the database development, the team will use the SMART mapping technique, validation and photo documentation. The team started its field survey with the informal pedicab terminal in Agham Road. They tried taking photo documentation of the area but a man blocked their camera. Once data is available, they will transfer it to an open source map like google earth to visualize the location of the terminals. After which, it will be converted to GIS format. The gist of the study is the spatial analysis to see how the data sets relate together. Proximity analysis or buffering will be used that involves creation of areas around a geographical entity based on measurement of distance. 23
  • 34.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 The goal of the research is to come up with a transit map, including pedestrian walkways. Study areas identified were North Edsa - Agham Road, Matandang Balara, and in Payatas where urban poor communities are concentrated. He also presented some preliminary results both in numerical and visual form where he showed partial mapping of the public terminals in North EDSA. Network analysis will be done once the network of terminals is in place. Mapping could be used as a tool to identify improvements in public transport system. He emphasized the importance of converting the result to GIS format and the conduct spatial analysis and apply to programs. B. Case Studies on the Mobility Characteristics, Cost and Issues of the Poor and Vulnerable Groups Mr. Randolph Carreon The study aims to understand the mobility characteristics, costs and issues of the poor and vulnerable. (See Annex M) Specifically it aims to:  Establish the travel demand patterns of the poor and vulnerable groups;  Look qualitatively into the efficiency of the public transport system vis-à-vis the needs of the poor and the vulnerable groups;  Estimate the cost of mobility of the poor;  Estimate the actual and desired cost of transport of those within the vulnerable groups; and  Examine other non–quantifiable costs, if any, incurred by the vulnerable groups Mr. Carreon defined first the poor and vulnerable using income as basis. They defined them as those living within the colonies of informal settlers. The selected study areas in QC were Purok Centro in Barangay Old Balara, Agham Road and GK Village in Payatas. The first one (Purok Centro) was chosen because it is along Katipunan and has been affected by the C-5 extension project. Second (Agham Road) was chosen because of its proximity to transport terminals and GK Village in Payatas because of the reforms made by GK present in the community. After doing all three, there will be inter-area analysis. Vulnerable groups were defined to include PWDs, senior citizens, women, children. The research woull also consider those working in the business process outsourcing firms whose office hours are irregular. The team of Mr. Carreon started with data gathering using household interviews. Public consultations were done to evaluate and validate the results of the interviews. Individual interviews, key informant interviews and focus group discussions would be conducted for the vulnerable groups. The primary data would also be supported by secondary data collection. As project update, Mr. Carreon said that they are now doing public consultation and that their data gathering would run from February to March 2012. He also presented the photo documentation of their data gathering and general findings in Purok Centro. The data showed that people primarily leave their house to go to work and school. Of the estimated total of 20,000 trips per day, aside from walking, the top 2 transport modes used are PUJ, and tricycle. Generally, the people said they would walk if they could walk. 24
  • 35.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 He presented numerical representation of average annual income and expenses divided into those who are renting and those who are not. The data were further sub divided into those with motor vehicles (MV), mostly 2 wheeled, and those without vehicles. Notable result was that it was still a rational choice for the community to invest on two-wheel MV. The perceived primary mobility problem the community saw was high transport cost while the rest share the same percentage (travel time, traffic congestion, availability of public transport vehicles, crowded public transport vehicles). The proposed solutions, still from Purok Centro, were all economic related such as work for additional income. Walking came out as their last resort. C. A Preliminary Inventory and Typology of Enterprise Models for Inclusive Mobility in Metro Manila: Of, By, and For the Poor and Vulnerable Ms. Tieza Mica Santos As introduction, Ms. Santos compared the transport mobility designs in our country similar as those of fashion victims. In most cases we see flyovers that somehow do not fit the actual needs of the people. The country tends to copy transport systems and designs of other countries not knowing that some of the designs do not fit in the context of Philippine mobility. She said that in adapting new mobility designs, the country has to consider policy, logistics, feasibility, economics and social aspects. (See Annex N) Commissioned to look at existing transport/ mobility related social entrepreneurship opportunities in the transport sector, they are also looking at sustainable innovative ideas and business models on new mobility and transport- related that have high potential for scale and replication, benefiting the poor and vulnerable sector and looking at the market barriers and enablers in terms of policy, economic and socio-cultural and lastly help in the creation of new platform, resource center and enabler of innovation. The research focuses on commercial and enterprise component of the transport and new mobility sector. Key variables would be barriers and enablers. In terms of methodology, they combined qualitative and quantitative. Focusing on 3 areas mentioned by Mr. Carreon earlier, their output will also include a template or a modeling featuring social entrepreneurship as a new mobility solution. They are specifically tasked to come up with:  Mobility challenges of the poor and vulnerable  Existing mobility business models  Emerging new mobility business models  Social enterprise opportunities for the mobility transport sector She presented the research questions they will use. The primary considerations for emerging new mobility sector she highlighted were:  Efficient (time to get to point A to point B)  Cost 25
  • 36.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012  Environmental  Convenience and Safety  Human-centered design principle Design thinking model will be used rather than the usual linear model design. Design thinking calls for more holistic and dynamic disciplinary approach to understand the problems. Instead of step by step process, it will look are how each key variable correlate to each other. This will show how new business models will emerge. Human-Centered Design (HCD) will help you hear the needs of constituents in new ways, create innovative solutions to meet these needs, and deliver solutions with sustainability in mind. Data gathering uses the qualitative method by secondary data analysis and RRL, FGD, KII and community consultation. Quantitative method would also be used through survey and area sampling. Social Entrepreneurship is defined as an activity, as an approach or methodology and as a business model. Social enterprises are categorized by nature, social aims and outcomes, and in terms of leadership and sectoral-base. The study team treats innovation both as a process and as an outcome. Barriers and enablers will look at:  Policy – standards and regulatory mechanisms  Economic – market model and supply-demand correlation  Socio-cultural – important deals with human ecology, cultural, anthropology, patterns of behavior, social context She presented a summary of pretest data gathering and the recurring themes or variables from the poor and vulnerable consisting of cost, length of travel, travel time, and access to basic goods and services in terms of cost of the goods. The team tried to capture the various products and services that can be attached to transport/ mobility. They also looked at how the community access information. Two recurring platforms were raised in terms of ICT access: mobile and Internet. In terms of affordability, these consumers are able to afford more information coming from mobile technology and Internet. In terms of information services, they invest too much on transport cost than service feature. In terms of willingness to pay, they are willing to pay around P7. Majority have difficulty in availing healthcare services and finding employment but the primary issue is not in terms of inaccessibility directly but more in terms of actual cost of goods due to lack of employment. 77% attribute their difficulty towards the cost of availing of these goods and services. In the process of RRL, the recurring themes that came up were: 1) sustainable transportation related to sustainable targets and sustainable legislation for transportation and land coordination policies/ designs, inter and intra-agency collaboration approach, agency prioritization and allocation process; 2) Energy efficiency, probably because of increasing oil prices and environmental health consideration. In addition are: multi modal mobility, multi-stakeholder approach, human patterns of movement, predictability of movement of goods and people and minimizing costs. In terms of barriers and enablers, they searched policy, economics and socio-cultural in literature. The recurring challenge in terms of policy was most of our regulatory frameworks are uncoordinated, fragmented, unsustainable and do not offer support for the development of sustainable pro-poor mobility structures. In terms of economics, current economic incentives are mostly private sector biased; 26
  • 37.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 mobility models are designed not to cater to human needs but for profit. Lastly, in terms of socio-cultural, urban development and transport system designs in Metro Manila are out of sync with patterns of settlement, human ecology, consumer behaviors, and unsustainable land and resource planning. Lastly, she presented a graphic representation of their main point, how the mobility designs are not in sync with the way people move. . The main goal of this New Mobility SE search through a human-centered design process is to understand the minds of the people and how goods and services should be delivered sustainably to cater the needs of the vulnerable. The study wants to understand how policy makers, urban planners and transport specialists envision the way cities are built, how transport systems are developed, how we think and re-think the way we construct Metro Manila. Understand first what do we make out of our cities and why has Metro Manila evolved into what it is today before going to the drawing boards and conduct urban planning. She reminded everyone the need to look at what is viable and feasible in designing mobility infrastructures. Look also at what is desirable and what caters to the actual needs of the people. It is often seen that the transportation systems shape the way people build their cities, but tend to neglect that it is human patterns of behavior and cultural activities that are at the center of how urban development should be designed. As Metro Manila reaches to a point of exponential growth, human needs dramatically change simultaneously with it. She wanted all to ensure that things fit like a puzzle and that city and mobility infrastructures are built central to human progress. Otherwise the country will continue to become fashion victims. XI. Open Forum QUESTIONS/ COMMENTS ANSWERS/ RESPONSES Benjie dela Peña: Acknowledged Randolph Carreon: key is to provide a representatives from Intellecap better public transport system (Manish Shankar and Bharat Bongu) who are also grantees of the Rockefeller Foundation. How do you solve people who say it is cheaper to buy 2-wheel MVs than commute or use public transport? Some considerations from Niña Zialcita of People Power Institute: a) Goal is to promote walking, goal of mobility really is to make cities more walkable in the sense that you are not endangering your lungs, breathing in toxic air etc. b) When mapping out transport hubs and terminals, please also consider flood zone areas. When we speak of the poor and vulnerable, everyone is vulnerable in flooding. It is safer 27
  • 38.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 to ride a pedicab than ride vehicles during flood. c) Consider also senior citizens and PWDs in mapping out the hubs. What will be the convenient options for them? d) Examine the option of not moving at all and not just moving around. Conduct dialogues to encourage carpooling and telecoms. Give incentives for carpooling and encourage people to conduct business online more and discourage 3-hour long meetings. Look for alternative modes of working that donot involve moving and open up additional avenues to do things and give options than having to travel. e) Once the mapping is available online, please share it with us. There are available similar mapping activities but for different goals or collaboration. Comments from Sheila Napalang from UP-NCTS: a) Agree on inclusive transport that are accessible to everyone including women and PWDs b) Informed everyone that the National Government has adopted an Environmentally Sustainable Transport Framework. She suggested looking at this framework and discovering how to mainstream this. There are many policies available out there but making it more digestible is important as well as making it accessible to people who will be using this. c) Access to the maps. If maps are 1) Benjie dela Peña: Maps on the available only in the internet, it may not internet are in open data format be very useful. Printed copies may be meaning any machine can read the data more practical to be posted on and interpret. He gave the example of barangay halls and are much acceptable Kibera in Africa, created by citizens to people. She provided an example on using GPS data. The idea, similar to the their study in Cebu where taxi drivers open street map concept, was to take the are willing to pay more to get info on data and turn it into a platform that traffic areas and where to get people can build things on in a form that passengers. people use like text messaging. 28
  • 39.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 2) Dr. Segundo Romero: He aspires to come up with large maps to be put up in public places. But in order to do this, there is a need to gather information first and translate the information to a form that can be easily understood by the public. Next is to print them out in different sections to be given to the private sector and be placed in big ad spaces like the ones found in SM Malls. However, to be able to do this properly, collection of data was deemed to be most crucial. d) Poor and vulnerable framing problem because poor may not be vulnerable and vice versa. What they need is access to information to have choices. We make the decision based on the information available to us. Some know but sometimes they do not have a choice. Information is power e) What are necessary to be included in the map? There may be confusion in terms of name: barangay, sitio. Recommended to use big landmarks rather than street names. XII. SMART Mapping Uncharted Connection Points in Metro Manila: The Participatory Mapping Workshop Approach and Process Ms. Susan Zielinski, Managing Director, SMART Centre University of Michigan Ms. Zielinski directly pointed out the core of this mapping exercise, which is how to customize and select people to map on and people to map with. This exercise brings together people that provide better representation of citizens or the community and not just planners. This evolved in a 4-step program. It starts by bringing together the private sector, small entrepreneurs, NGOs, planners, government from a wider range (e.g. social services, innovation, IT, economic development, tourism, finance, marketing). They all need to come together and understand that the need for mapping is the first step. Mapping essentially to create a tool, which people can dissect. Usually people talk about what is not working but in mapping, people need to see it the other way by identifying what works great and positive and exciting. Instead of presenting negatives, present them as challenges that will be solved. During the exercise, participants must build on what is there, preload all the different modes of transportation, overlay everything (tricycles, airports, boats, PUJs etc.) and look at connections. Eventually the exercise will reveal a mobility grid. Next, participants must identify where they can pilot their ideas. It is just a matter of identifying what you want to accomplish. It hopefully aims to raise economic opportunities by identifying opportunities for economic development. She asked for a shift in mobility language to a more positive outlook. She also deemed it important to create a vision and multiple ideas in order for the 29
  • 40.
    Catalyzing New Mobilityin Cities: The Case of Metro Manila Project Launch 31 January 2012 mapping exercise to work. This interactive exercise ultimately builds communities and when hooked up with GIS, it tells a story to policy makers. XIII. The Way Forward for the New Mobility Project: Building a New Mobility Constituency Dr. Segundo Joaquin Romero, Director, iBoP Asia Program Dr. Romero was keen to see stakeholders interested in getting this project forward. ASoG through iBoP Asia offers a series of forum by people can habitually discuss new mobility. The event we are having is a large forum. The Project will be conducting several medium, small and large fora over the next several months to pursue this discussion. He informed everyone of a mapping project using SMART mapping framework and on-line platform as well as coordinating work. He was certain that stakeholders are out there just waiting to be organized. He hoped to bring in more people than the usual and be able to use the convening power of the academe. The event ended at around 4:00 pm with everyone invited to attend the pilot New Mobility Mapping Workshop led by University of Michigan-SMART Centre the following day. 30
  • 41.
    ANNEX A List of Participants
  • 49.
    ANNEX B Eagle Eyes Articles
  • 50.
    Annex B ____________________________________________________________________________________ New mobility1 Lastweek I began a new series of columns on the transportation challenges of Metro Manila, proposing a change of paradigm from understanding our current problem to be one from traffic to a transportation, or better still a mobility, perspective. When I sent that first column to Fr. Jett Villarin SJ, president of the Ateneo de Manila, he reminded me to also propose solutions to the problems I exposed. That is exactly what I do in today’s column, written again with the research collaboration of Christian Laluna and the Innovations for the Base of the Pyramid team of the Ateneo School of Government which is implementing with the Metro Manila Development Authority a Rockefeller Foundation-sponsored project on Manila’s transportation challenges. In this column, I propose an overall vision for solving our transportation challenges, a vision defined by a concept I introduced last week, that of “new mobility.” New mobility’s convenience and reliability is rooted in a simple phrase used by Susan Zielinski of University of Michigan’s Sustainable Mobility and Accessibility Research and Transformation: “More choices, more connected choices.” Breaking it down, Zielinski describes new mobility as “open source, multi-modal, multi-service, IT-enhanced user focused, socially equitable, aesthetic livable whole systems transportation.” It combines innovative transportation and communication technology with smart urban planning, human-friendly engineering and design, and an emphasis on social equity, so that the poor, the handicapped, the young, and the old (and yes, the rich, too!) can get anywhere in the metro for work and play, even without a motor vehicle of their own. The real game changer, according to Zielinski, is what turns “public transport” into “urban mobility”: modality and seamlessness. It’s connecting all the mobility options of the metro—cars and bikes, buses and trains, modes and services and technologies, public and private—into a smooth-flow network that anyone can use, so that there’s no place in the city that you cannot get even without a single occupancy vehicle. The technology of this future already exists today, thanks to the innovative drive of cities similar to Metro Manila, plagued by their own mobility woes, but refusing to surrender to them. Bus Rapid Transit, known also as Busways, for example, was pioneered by the Brazilian city of Curitiba in 1974, but has seen wide adoption (Zelinski describes it as “gone viral”). BRT uses full-time bus-exclusive lanes to practically turn buses into trains: a continuous, flowing service much like the LRT/MRT, but without the heavy construction and investment costs of city rail systems. I have seen the effectiveness of a BRT system as I have used it in Jakarta where the TransJakarta Busway is designed on the simple concept of building elevated platforms (operating as bus stations) where passengers get on and off the buses. Other places where BRT has successfully been introduced include Bogota (Colombia), Guangzhou (China), Istanbul (Turkey), Sao Paolo (Brazil), Mexico City, Seoul (South Korea), Adelaide (Australia), Los Angeles (California, USA), and Portland (Oregon, USA). The Transmilenio BRT in Bogota carries more passengers than 95 percent of the metro (subway or light rail) systems in the world and they built Phase 1, all 41 kilometers, in just 8 months. In Metro Manila, the best roads to pilot a BRT system are C-5 (already in 1 http://www.manilastandardtoday.com/insideOpinion.htm?f=2011/november/8/tonylavina.isx&d=2011/n ovember/8
  • 51.
    Annex B ____________________________________________________________________________________ the plansof MMDA) and Commonwealth Avenue where BRT would be a much faster and cheaper solution to the planned Light Rail Transit line for that roadway. Indeed, aworld- class BRT service can be built faster with full roll-out counted in months, not years, for just a third of the cost of fixed rail transit. Another emerging urban transport technology or practice is “fractional use” where people, instead of owning their own vehicle, can instead rent a personal-use vehicle for any amount of time for the day. For example, Zipcar (www.zipcar.com) in the United States offers standard fuel or hybrid-engine and electric cars for rent to service members. It’s like time-sharing for cars. Thanks to economies of scale through fractional use, members thus enjoy lower mobility costs than if they had to own and maintain their own vehicle. France and a few countries in Western Europe are experimenting with peer-to-peer car sharing, where anyone can share their car and get paid for the use. Yet cars need not be the only product offered: fractional use has also been used with bicycles (both human-powered and electric) or rickshaws, which are perfect for getting around an area like the Makati or Ortigas Central Business Districts, without taking up too much parking and road space. There are many very successful bike sharing systems around the world, including Paris’ Velib; Washington D.C.’s Capitol Bikeshare; Mexico City’s Ecobici and Montreal’s Bixi. Nearer to home, Guangzhou’s bikeshare is integrated with its BRT and metro systems and you use the same fare card to pay for either. India is contemplating a roll-out of bike-sharing services as part of massive national investment in urban infrastructure. These transportation systems should be smartly networked, and also take advantage of new technologies or other infrastructure, to increase their convenience and ease of use for the general public. Zipcar, for example, uses apps installed on iPhones as part of its service. In China, you can also shop and pay for other services using the Yan Cheng Tongvalue card. Here in the Philippines, SM movie houses are taking advantage of cellphone-swiping to claim cinema seats, and a similar service was once offered on the MRT. An entrepreneur can easily take advantage of Metro Manila’s telecommunications and Internet infrastructure to enable a fractional ownership mobility service for use by anyone from Ayala Alabang to Tondo. Lets imagine what can happen with new mobility. Take anyone of my law students (I teach in the University of the Philippines College of Law in Quezon City, Ateneo School of Law in Makati, De La Salle College of Law in Manila) living in Alabang, who has her own car but hates the traffic jams along C-5, Edsa or South Super Highway. Instead of driving all the way to Quezon City, Makati or Manila, she could take the South Luzon Expressway (SLEX) to a convenient multimodal transportation hub in SLEX that has been constructed to network mobility options. She can park her car at a garage in this hub (or use a web-enabled, real-time ridesharing program like www.goloco.comor www.pickuppal.com), and take the C-5 BRT, EDSA MRT or TAFT LRT which connects to other options for her ultimate destination. Of course, it would even be better, if at some point, we are able to connect this hub through bicycle lanes that bring my student directly from and to her home - and even better still, at the end of the BRT/MRT/LRT lines, such bicycle options also exist. This vision of the future for Metro Manila, enabled by new mobility, shows how good policy and smart thinking that brings together public efforts, private-sector innovation and social entrepreneurship can address our transportation crisis. The Ateneo School of Government hopes to move this along in January 2012 when we convene a mapping exercise with stakeholders and launch the new mobility program with MMDA. In working together, we secure our mobility future and renew our city.
  • 52.
    Annex B ____________________________________________________________________________________ Moving MetroManila - Eagle Eyes by Tony La Viña Date posted: 2012-02-01 14:59:48 With this column, I resume the series on the transportation challenges of Metro Manila. I started the series last October written with the assistance of colleague Christian Laluna, If readers recall, I emphasized in the first two columns of the series the importance to re-frame what we are facing in our metropolis, moving away from a traffic paradigm to seeing the challenge from one of transportation and mobility. This is an opportune time to raise transportation issues once again given the positive developments last week in the Metropolitan Manila Development Authority, led by Chairman Francis Tolentino, which finally got all the local governments in the region to agree to a unified traffic ticketing system. Today also, in its Loyola Campus, the Ateneo School of Government is formally launching the New Mobility SMART (Sustainable Mobility and Accessibility, Research, and Transformation) Mapping Activity, an opportunity to invite Metro Manila to sit down together and rethink how we get about our cities, between our homes and our destinations, and begin the transformation of our megacity from its present gridlock to a vision of mobility for all: Equitable, economical, environment-friendly, and efficient. It is part of ASoG’s efforts to unlock the full potential of Metro Manila, of its infrastructure, and of its people―especially the urban poor. It is acknowledged that the poor depend on publicly available mobility options more than the rich for employment, security, health, socialization, and leisure purposes. It is how they get to work, school, other family and friends, and meet their own needs and developmental goals. Without public transport, notes an Overseas Development Institute report on the subject, the poor are cut off from economic opportunities, denied social services like health and education, and even stripped of their voice in the public arena, because they cannot freely gather to exchange ideas and assert their rights and interest in the political sphere. Indeed, there is an overriding interest of the state to improve mobility for its citizenry, because it can improve economic efficiency and reduce poverty. Not all transportation development initiatives help the poor, though. In fact, the poor are often the first to suffer from transportation infrastructure development. Building more roads alone doesn’t necessarily help the poor because it emphasizes a priority on car ownership, which Metro Manila’s urban poor cannot, or can barely, afford. Moreover, the right-of-way needed to construct these roads all too often run through urban poor communities, displacing them from their homes, and often times without relocation to an area of their convenience. The poor do have alternative options for getting around the city other than private cars or public transport. Bicycles have become an increasing sight on roads all in the Metro mostly used by security guards and construction workers but there are no specific lanes dedicated for them except in Marikina, a laudable foresight for the city. Bikers have to share the same road space as vehicles, with detrimental safety effects. Worse yet, most drivers act as though they feel entitled to the road, and consider bikers a nuisance to be rid of―not a mobility-friendly attitude among those lucky enough to own their own vehicle. In addition, those who are lucky enough to be in walking distance of their
  • 53.
    Annex B ____________________________________________________________________________________ destinations usuallydo not have good pedestrian facilities. Gender and age also play a role in patterns of mobility, and the corresponding mobility price. Studies show that women are often household managers and caregivers for children or the elderly, and their trips are more frequent and irregular than the 9-5, work-to-home commute of the average breadwinner. This means that they have higher mobility costs, measured either by bus/jeep fares or gasoline budgets. Children, the elderly, and the handicapped often require assistance to use public transportation―the steep steps and elevated doors of buses, for example, prevent the use of wheelchairs, and make the use of crutches and walking sticks a difficult, even painful chore. Overcrowding these buses during rush hour only adds to the undeserved burden of the infirm and elderly. Finally, as is in the nature of poverty, it is the poor who are the most vulnerable to shocks and dislocations to the transport network. We see this every time heavy rains drench Manila, or a transport strike erupts. Often running on a tight budget, when the buses or jeeps become unavailable on a given route due to flood or strike, commuters might not have enough money for pricier options such as point-to-point and route-FX taxis, or to take alternate, operating routes. Also, increasing gas, toll, and commodity prices often drive bus and jeep fares up, impinging further on limited wallets. While we have discussed transportation and poverty as it affects the poor from the demand side, we cannot ignore the supply side of the equation. The employees of bus companies are nearly always of the same social and economic strata as their passengers, while jeepney and tricycle drivers either own their vehicle or drive on behalf of the owner, usually a relative. In either case, these people are also dependent on the transport industry, but with an added twist: as the pressures of population, economy, technology, and politics transform Metro Manila mobility, these drivers and operators will see the basis of their income change as well. They may be resistant to the added costs of new initiatives, like improvements to engines, or making their vehicles handicapped-friendly, especially when they feel it will come out of their pockets. Fearing a negative impact to their jobs or their incomes, they would form the basis of any inertia against changes to the transport sector. We must be therefore fair: any changes proposed for Metro Manila bus, jeepney, and tricycle services should also benefit the drivers and operators who depend on this industry for their income. It does not take rocket science to get this done. Later in these series, I will make specific proposals about what could be done. This is the challenge to policy-makers and other stakeholders of urban mobility: We have to expand the options available for mobility, introduce new methods of getting around the Metro, and make them safe, economical, and easy-to-use for the marginalized: the poor, the old, women and children, and the handicapped. Even as we do this, we have to ensure that those who work in the transport sector can find dependable income and social security from their line of work. And it can only be done when everyone, driver and commuter, policy-maker and citizen alike, can raise their voice and join hands in the same arena. This is what Ateneo School of Government’s New Mobility initiative is all about. With the support of the Rockefeller Foundation and in partnership with the MMDA, New Mobility (we nickname it NeMo) is about making the business of mobility work: sustainably, efficiently, and economically. We need the right incentives: on the demand side, for flexible personal mobility through multiple options, and economic convenience and ease of use; on the supply side, for sustainable income, disciplined driving, an emphasis on
  • 54.
    Annex B ____________________________________________________________________________________ the needof the customer-commuter for reliable transit options, and openness to reform, improvement, and innovation. Through NeMo, we hope to contribute to the transformation of Metro Manila into a megacity truly on the move.
  • 55.
    ANNEX C TheiBoP Asia Program
  • 56.
    Ateneo School ofGovernment 3/5/2012 Catalyzing New Mobility in Cities: The Case of Metro Manila Project Launching Ateneo de Manila University January 31, 2012 with generous support from The iBoP Program Segundo Eclar Romero, PhD Director, iBoP Program Ateneo School of Government 1
  • 57.
    Ateneo School ofGovernment 3/5/2012 The iBoP Concept “Innovations at the Base of the Pyramid” in Southeast Asia (iBoP Asia) Two Concepts of BOP • A socio-economic designation for the 4-5 billion individuals that live primarily in developing countries and whose annual per capita incomes fall below $1,500 (in PPP terms); and • An emerging field of business strategy that focuses on products, services, and enterprises to serve people throughout the base of the world's income pyramid. • Both concepts are also often referred to as the “Base” or "Bottom of the Pyramid" or the "BoP". • -- http://www.brinq.com/resources/bop 2
  • 58.
    Ateneo School ofGovernment 3/5/2012 • Above the BoP are the MoP (Middle of the Pyramid: annual incomes between $3,000 and $10,000) and ToP (Top of the Pyramid: incomes above $10,000 per year). Examples of ToP populations would include much of the U.S., Europe, and the economic elite throughout the world, while examples of the MoP would include poorer people in developed nations as well as the rising middle class in the developing world. • -- http://www.brinq.com/resources/bop The Base of the Pyramid (BOP) • A 5 trillion dollar, 4 billion person market with significant unmet needs • 4 billion low-income people – the majority of the world's population – constitute the base of the economic pyramid (BoP). They live in relative poverty with an annual income below $3,000 and have significant needs resulting from, or impacting, climate change, the digital divide, malnutrition, hunger, health, poor sanitation or access to water. • Today's individualistic approach is collectively inefficient and, together with the dependency on donations, leaves the BoP fallow. • Low-income does not mean no income. Together, they have substantial purchasing power and represent a $5 trillionglobal consumer market[1], suggesting a range opportunities for market-based approaches to better meet their needs and empower their entry into the formal economy. 3
  • 59.
    Ateneo School ofGovernment 3/5/2012 iBoP Stakeholders • Engage government, private sector, non-government, and international sectors: redirect, catalyze, and synchronize the creative energies • Engage the poor and vulnerable sectors in Southeast Asia towards their own development • The Program was established in 2007 with Dean Antonio La Vina as concurrently its first Director SEA countries • The region is moving towards regional integration (ASEAN 2015) as many SEA countries have attained high economic growth trajectories • Increased innovation capacity in in Singapore, Malaysia and Thailand drive this economic growth and other countries aspire to jumpstart their own innovation systems. 4
  • 60.
    Ateneo School ofGovernment 3/5/2012 • Innovation policy in Southeast Asia, however, is more focused on economic and industrial development and less on poverty alleviation and inclusive development. • As economic growth increases, inequality also increases and the poor and vulnerable suffer unequal access to resources, basic services, and employment opportunities. Innovations for Inclusive Development • Innovations must be purposively geared towards inclusive development. • “Innovations for inclusive development” (IID) is understood as “innovation that reduces poverty and enables as many groups of people, especially the poor and vulnerable, to participate in decision-making, create and actualize opportunities, and share the benefits of development.” 5
  • 61.
    Ateneo School ofGovernment 3/5/2012 The iBoP Asia Program currently pursues a two track program • Universities and Councils in Innovations for Inclusive Development in Southeast Asia • New Mobility in Metro Manila Early Insights • Los Banos farmer, Purok Centro community • Telecom – 97% with celfones and save time but … • Need to innovate and reinvent intermediaries, including governments and universities) • iBoP is about mindshift 6
  • 62.
    Ateneo School ofGovernment 3/5/2012 Other Program Areas of Concern • The iBoP Asia Program is a new program. • It aims to seek other opportunities and pathways for promoting inclusive development, including mobility, by enlarging its project portfolio by seeking new partners and new pathways towards inclusive development. The iBoP Team • Within the Ateneo School of Government, the iBoP Program belongs to the “Poverty” Key Practice Area, with Assistant Dean Mary Jean Caleda as focal person. • The Director of the iBoP Program is Dr Segundo E Romero. The Program Resource Group (that provides support at Program as well as joint support for the projects) consists of Ms Jessica Bercilla, Senior Research Associate, Ms Cddqa Rogel, Communications Associate, Mr Andre Quintos, Web and System Administrator, and Kristian Torres, Project Associate. 7
  • 63.
    Ateneo School ofGovernment 3/5/2012 iBoP Project Teams • The UNIID-SEA Project Manager is Ms Grace Santos, assisted by Ms. Lilac Caspe. • The New Mobility Project Manager is Dr Danielle Guillen, assisted by Mr Lorenzo Cordova Jr, Research Associate. • The iBoP Asia Team is a multidisciplinary team that works with various centers in Ateneo such as the Ateneo Innovation Center and the Ateneo Center for Social Enterprise, various private sector, non-governmental organizations, and international organizations. Volunteers, OJT, Dissertation, Thesis-writers, Practicum Students • The iBoP Team encourages students, volunteers, senior citizens, and other citizens to participate in its programs and activities. The iBoP Team is committed to providing opportunities for service, learning, and fulfillment to its stakeholders and partners. 8
  • 64.
    ANNEX D Universities andCouncils Network for Innovation for Inclusive Development in Southeast Asia
  • 65.
    3/5/2012 Universities and Councils Network for Innovation for Inclusive Development in Southeast Asia (UNIID-SEA) REGIONAL CONTEXT: SOUTHEAST ASIA  Spectacular economic growth and increased poverty reduction over the last 3 decades.  Rising inequality (Gini coefficients of SEA countries: .34 – .44) 1
  • 66.
    3/5/2012 REGIONAL CONTEXT: INNOVATION andDEVELOPMENT The innovation trajectory that led to rapid growth in SEA (most evident in Singapore, Malaysia, Thailand) has tended to exclude the poor and the social challenges that they face, which exacerbates poverty and inequality. REGIONAL CONTEXT: INNOVATION and DEVELOPMENT  Social justice, equality and human rights are not deeply embedded in innovation systems and social/ political structures.  Development = economic, industrial growth; social development only secondary. Photo from www.sxc.hu 2
  • 67.
    3/5/2012 A NEW PERSPECTIVE: INNOVATIONFOR INCLUSIVE DEVELOPMENT (IID) IID is understood as “innovation that reduces poverty and enables as many groups of people, especially the poor and vulnerable, to participate in decision-making, create and actualize opportunities, and share the benefits of development.” Innovation for all, by all. UNIID-Southeast Asia (UNIID-SEA) was conceived by the Innovation at the Base of the Pyramid in Asia (iBoP Asia) Program of the Ateneo School of Government and IDRC to:  Facilitate university and research council reinvention for IID by integrating IID in the core missions of teaching, research and extension (university), and priority setting, grant making and policy making (councils).  Establish formal and sustainable partnerships and collaborations between SEA universities and research councils, to foster innovation research that links to/ informs social policy.  Form the UNIID-SEA Network of universities and councils, and connect to other UNIID networks (South Africa, Latin America, South Asia). 3
  • 68.
    3/5/2012 UNIID-Southeast Asia (UNIID-SEA), in the long term, aims to foster Multidisciplinary, multi-stakeholder and multi-level (national, regional, global) approaches, mechanisms and partnerships towards IID. UNIID-Southeast Asia (UNIID-SEA) Identified partners and core network members UNIVERSITIES COUNCILS Ateneo de Manila University (PHL) National Research Council of the School of Science and Engineering and Philippines (LEAD ORG) School of Government (LEAD ORG) National Research Council of Chulalongkorn University (THL) Thailand Department of Urban and Regional Planning Dewan Riset Nasional-Indonesia and Graduate School of Technology and Innovation Management National Council for S&T Policy Institut Teknologi Bandung (IND) - Vietnam School of Architecture, Planning and Public Policy Hanoi University of Science and Technology (VNM) Faculty of Economics and Management 4
  • 69.
    3/5/2012 UNIID-Southeast Asia (UNIID-SEA) Network structure UNIID-LA, UNIID-South Africa, UNIID-South Asia HUST ITB NRCT ASoG Technical Committee NRCP DRN UNIID-SEA Project Chula AdMU NRCV CONNECTIONS: a) Intra- and inter- SUPPORTED BY: university Regional knowledge-building and b) Intra- and inter-council Information sharing platforms. c) Universities-Councils UNIID-Southeast Asia (UNIID-SEA) Key components/ activities for 2012-2015 Knowledge- and Capacity-building IID Research Support - Baseline study of SEA - IID Research Awards for universities and councils - Multidisciplinary IID Course Universities Module and Open Courseware - Innovation Challenge with dev’t and piloting Engineers Without Borders- - Social Innovation Lab (TBC) Australia (in the pipeline) - IID Conferences with faculty & students Link to Policy - IID Workshops with Network-building Councils - UNIID-SEA and UNIID - University-Council linkage Global Consortium (i.e. harmonizing R&I agendas; policy research collab) - IID Agenda for ASEAN 2015 5
  • 70.
    3/5/2012 UNIID-Southeast Asia (UNIID-SEA) Work Program for 2012 YEAR 1 Major Project Activities Q1 Q2 Q3 Q4 Baseline study of universities and universities in SE Asia Dev’t of web portal (UNIIDSEA.ibopasia.net) Project launch and Planning Workshop with partners (APRIL 2012) Dev’t of IID Course Module and Open Courseware IID Research Awards for Universities Workshop with Councils UNIID-Southeast Asia (UNIID-SEA) Project Team National Research Council of the Philippines Dr. Segundo Joaquin Romero Dr. Cecilia Reyes Program Director, ASoG-iBoP Asia Executive Director, NRCP Program Project Manager – Council Component Mary Grace Santos Carmen Moreno Project Manager – University Component Project Associate – Council Lilac Caspe Component Research Associate Marie Cddyqa Jaya Rogel Communications Associate Dr. Ellie Osir Senior Program Specialist Southeast and East Asia Program 6
  • 71.
    3/5/2012 UNIID-Southeast Asia (UNIID-SEA) Visit our web portal: www.ibopasia.net Contact us: Dr. Doy Romero: doyromero@yahoo.com Grace Santos: mgpalaciosantos@yahoo.com Trunklines: +632 426 6001 local 4639 or 4646 Telefax: +632 929 70 35 7
  • 72.
    ANNEX E Catalyzing NewMobility in Cities Project: Finding New Mobility in Metro Manila
  • 73.
    Ateneo School ofGovernment 3/5/2012 Background and Purpose • The Search focuses on the use of New Mobility as a lens in search of more Catalyzing New Mobility in Cities: sustainable and innovative solutions in the Finding NewMo in Metro Manila urban public transport system in Metro Project Launch Manila, in particular, ensuring that the needs of the poor and the vulnerable are met. SDC Auditorium, Social Development Complex, Ateneo de Manila University January 31, 2012 with generous support from Some concepts New Mobility Mobility – is both the ability of a person (including the goods that the community needs) to travel to • an initiative that is multi-disciplinary, multi-sector, top- destinations of choice and the amount of movement bottom, bottom-up approaches like social enterprise and time necessary to do so. innovations in mobility addressing a socially inclusive transport sector Transportation- is the movement of people, animals and goods from one location to another. The field is • incorporates the dimensions of sustainability in divided into infrastructure, vehicle and operations. transportation such as social equity, economic, financial, health, ecology, physical environment, air quality, noise and climate change • based on the premise that as complexity increases, the notion that a single solution to solve transportation challenges decreases An engineer may envision solutions that include infrastructure or fuel but may not link them enough to urban design, policy and Goals & Objectives community behaviour. An urban planner may develop • To develop a new platform, resource centre, and ground-breaking approach to land enabler of innovation for purposes of governance use and urban design without ensuring socially inclusive mobility in the region. paying much attention to new services like car-sharing, bike sharing etc. • to utilizeand complement existing studies by initiating a metro-wide conversation among stakeholders to introduce New Mobility and An IT developer may come up find out how the stakeholders envision the with unique system to fare future of transport system in Metro Manila. payment, journey planning or traffic mgt. but may not spend time on linking to land use policies. 1
  • 74.
    Ateneo School ofGovernment 3/5/2012 Finding “NewMo” (New Mobility) in Objectives Metro Manila •to determine through research the impact and cost of essentially means taking myriad steps that all the current public transport system on the poor and the lead to a paradigm shift— vulnerable sector of the society (including BPOs) • by looking at the big picture • to identify new or emerging entrepreneurial or •focusing on people’s needs and wants especially livelihood opportunities in the transport sector that of the urban poor and the vulnerable responsive to the needs of the poor and the vulnerable groups sector •evolution of transport as attention turned to energy efficient mobility models, shared transport schemes and community owned transport. NewMo Forum Series : Let’s Talk NewMo NewMo Forum Series : Let’s Talk NewMo • isa venue for people to habitually meet to •GOAL : to sustain a conversation among these share information, ideas, insights, and stakeholders about how citizens can be empowered initiatives for taking action at the community to shape the patterns of mobility and access in level and increase the advocates of better Metro Manila to be more inclusive mobility and access to transportation in Metro Manila-especially for ordinary Manileña, the •CHALLENGE: to promote non-motorized transport (NMT) such as walking and biking, public transport poor, and the vulnerable. (paratransit, buses, BRTs and trains), elimination of unnecessary travel through the smart use of traditional and cyber communications Researching NewMo in Metro Manila Engaging the General Public for NewMo Through research, the Project will Mapping for Inclusive Mobility: Pinpointing Transport •explore how the current public transport system Hubs and Terminals affects the poor and vulnerable populations of Metro Manila by mapping the current public transport -this activity aims to build a community of people system; wanting to create a platform or build on available platform to improve information generated in maps for •Understand the mobility patterns, cost and issues of seamless multi-modal connections would benefit not the poor and the vulnerable groups; only the poor and the vulnerable groups but the •Seek new or emerging entrepreneurial or livelihood general public opportunities responsive to their mobility needs. 2
  • 75.
    Ateneo School ofGovernment 3/5/2012 Search for “NeMo” Business Models: iNewMo “NeMo” Social Enterprise and Social Innovations Awards 1.inquiries •To surface enterprising solutions to solve social mobility 2.information problems 3.interest • To engage different stakeholders in solving pressing mobility problems in the megacity especially that of the 4.insights poor and the vulnerable sector 5.initiatives •To document existing social enterprises in the transport sector and generate innovative ideas that address mobility 6.innovations problems and needs. 7.interconnections Thank you! Please contact: Marie Danielle V. Guillen, PhD. Manager Catalyzing New Mobility in Cities: The Case of Metro Manila Project iBoP Asia Program Ateneo School of Government Telefax: 9297035 Email: NewMobility.Ph@gmail.com 3
  • 76.
    ANNEX F Mapping for Inclusive Mobility: Pinpointing Transport Terminals and Hubs
  • 77.
    Ateneo School ofGovernment 3/5/2012 MAPPING FOR INCLUSIVE MOBILITY: Pinpointing Transport Terminals and Hubs LORENZO V. CORDOVA, JR. EnP Catalyzing New Mobility in Cities: The Case of Metro Manila Project Launch SDC Hall, Social Development Complex, Ateneo De Manila University January 31, 2012 with generous support from KEY CONCEPTS Modes of Public Transportation Public Transport Hubs Public Transport Terminals Informal Transport Terminals Engaging stakeholders in mapping 1
  • 78.
    Ateneo School ofGovernment 3/5/2012 Modes of Public Transportation in Metro Manila Each plays major role in mobility especially of the poor and can either compete or play complementary role to other forms of public transportation Public Transport Hubs 2
  • 79.
    Ateneo School ofGovernment 3/5/2012 Public Transport Terminals Informal Public Transport Terminals/ Hubs Areas that are public or privately owned used by motorized and non-motorized public transportation vehicles as terminals, but have no clear legal provision and or local government ordinances that support its existence. 3
  • 80.
    Ateneo School ofGovernment 3/5/2012 Pinpointing Public Transport Terminals and Hubs Metro Manila have complex and diverse transportation modes. Unaccounted public transport terminals and hubs. We know they exist, but we lack readily available and accessible information where they are. Lack of capability of LGUs and other government agencies to produce up-to-date maps Mapping requires much time and resources. Commuting in the Metro Connection points? Choices? Efficiency? 4
  • 81.
    Ateneo School ofGovernment 3/5/2012 MAPPING FOR INCLUSIVE MOBILITY Locating and mapping transport terminals are crucial in order to assess the mobility problems and opportunities in Metro Manila. Improving information generated in maps for seamless multi- modal interconnections would benefit not only the poor and the vulnerable groups but the general public. Build a community of people wanting to create that platform or build on available platform. Terminals (tricycle, jeepney, and bus) in Brgy. Bagong Silang, Caloocan City Tricycle terminals are located in many areas in the Barangay. Bus uses vacant lot and roads as terminal. The jeepney also uses the roadsides, vacant lots and rotonda as terminals 5
  • 82.
    Ateneo School ofGovernment 3/5/2012 Findings: • Excess of tricycle terminals (using walkability distance from HLURB of 200m) • Tricycle terminals are either on the streets or shares space with pedestrian sidewalks MAPPING FOR INCLUSIVE MOBILITY Individuals and organizations as contributors Intermediation platform – “enabler” Users 6
  • 83.
    Ateneo School ofGovernment 3/5/2012 MOBILITY MAPPING – HI-TECH AND HI-TOUCH METHODS • Some applications of ICT and existing web-based platforms: Openstreetmap Google Map Maker SeeClickFix Cyclopath Waze Interaksyon.com & MMDA 7
  • 84.
    Ateneo School ofGovernment 3/5/2012 POSSIBLE INFORMATION FROM STAKEHOLDERS • Mode of public transportation (tricycle, pedicab, jeepney etc.) • Location of terminal/ hub • Name of TODA, JODA, PODA etc. • Number of members • Destinations/ Routes • Time of operation • Facilities and services available in the terminals/ hubs MAPPING FOR INCLUSIVE MOBILITY 8
  • 85.
    Ateneo School ofGovernment 3/5/2012 MAPPING FOR INCLUSIVE MOBILITY • Locating and mapping these hubs and terminals will improve the quality of information through collaborative public process. • Increase awareness among stakeholders of mobility in Metro Manila especially the users of public transportation. • Expand useful data available data for decision- makers while enabling much broader spectrum of citizens to actively participate in citizen science in their own communities, and to contribute their collective opinions and decisions. • This method increase efficiency to the generation of data and reduce costs. MAPPING FOR INCLUSIVE MOBILITY • A community of people wanted to create or build on existing platforms (“Prosumers”); •Maps generated will be made available on-line - a community resource and not proprietary in nature; • Should be able to generate discussion streams on the state and improvements of the transport system of Metro Manila. • This is an evolving activity – new approaches may become available over time 9
  • 86.
    Ateneo School ofGovernment 3/5/2012 THANK YOU! 10
  • 87.
    ANNEX G Search for New Mobility Business Models in Metro Manila
  • 88.
    Ateneo School ofGovernment 3/5/2012 Catalyzing New Mobility in Cities: The Case of Metro Manila New Business Model Search with generous support from Best “NeMo” Social Innovation Concept Awards • The entries in New Mobility social innovations concepts/ideas and solutions should be inclusive and at the same time responsive to selected mobility problem(s). The process is solution-seeking task. 1
  • 89.
    Ateneo School ofGovernment 3/5/2012 What Innovation? • 'Product innovation’ – ideas on changes in the things (products/services) addressing mobility issues • 'Process innovation’ – ideas on changes in the ways in which mobility products and services are created or delivered • 'Position innovation’ – ideas on changes in the context in which the new mobility products/services are framed and communicated • 'Paradigm innovation’ – changes in the underlying mental models that address new mobility issues Adapted from 4Ps of Innovation by John Besseant and Joe Tidd Humanitarian Innovation Fund Best “NeMo” Social Enterprise Awards • The entries in best existing or emerging social enterprise in the transportation sector should be responding to selected new mobility problem(s) ,especially that of the poor and vulnerable • The entries must reflect sound management and should be properly documented 2
  • 90.
    Ateneo School ofGovernment 3/5/2012 Specific Criteria for the Social Enterprise Awards • Must be a social enterprise • Must have a specific a business model addressing New Mobility concerns in transportation of the poor and vulnerable Specific Criteria for the Social Enterprise Awards • Must have a business model where capabilities of the business, public and citizen sector are leveraged to deliver needed goods and services to marginalized populations such as the Base of the Pyramid (BoP) with the achievement of multiple bottomlines as the end goal. 3
  • 91.
    Ateneo School ofGovernment 3/5/2012 Specific Criteria for the Social Enterprise Awards The multiple bottom lines of the business model include (but are not limited to): • Surplus or profit generation, where profit is reinvested for the gain of the stakeholders and further pursuing the social objective • Environmental health • Preservation of cultural integrity and diversity • Capacitation or empowerment of a sector or community simultaneously improving their quality of life Example: Cargo bikes of WorldBike 4
  • 92.
    Ateneo School ofGovernment 3/5/2012 Mini-Bus Operation, Day Care Transport, Special Education Needs Transport by the HCT Group in UK Agency Community Transport Model and Transport Asset Management Riders for Health 5
  • 93.
    Ateneo School ofGovernment 3/5/2012 Non-emergency Medical Transport by Tranmedic Example: Mobility Scooter by Rugged Tree 6
  • 94.
    Ateneo School ofGovernment 3/5/2012 Common Criteria Presentation • Clear identification of mobility issues being addressed especially with those of the urban poor and the vulnerable groups • Employ approaches that incorporate principles of sustainability in transportation that address issues in ecology, social equity, health, finance and economy, air quality, noise, climate • Clear identification of challenges being addressed and of success indicators Schedule • Launch : January 2012 • Formal Calls for Nomination for: mid Feb-Mar 2012 • Committee deliberation: April 2012 • Possibility for Presentation to Rio Entrepreneurship Summit: May 2012 7
  • 95.
    ANNEX H New MobilityInitiatives of the MMDA
  • 96.
    NEW MOBILITY INITIATIVES IN METRO MANILA ATTY. FRANCIS N. TOLENTINO MMDA Chairman CURRENT PROGRAMS AND PROJECTS 1
  • 97.
    1600 X 1400CARLIFT 6 PAX CAPACITY WITHOUT WHEELCHAIR 5 PAX CAPACITY WITH WHEELCHAIR FICEM BOARD CLADDING GI SHEET ROOF SKYLIGHT ROOFING ALUMINUM LOUVERS ROOF PLANTERS 900 mm DOOR OPENING FICEM BOARD CLADDING • 1 meter high elevated platform • Automatic bus bay boarding gate and door with short range sensors • Customized bus floors aligned with the boarding platform • Manually operated ramps for the elderly and PWDs • CCTV cameras and alarms 2
  • 98.
    • Macapagal Avenue •Commonwealth Avenue • EDSA (February 14, 2012) Provides Traffic Advisories and Road Safety reminders to guide road users EDSA Main Avenue (South Bound) 3
  • 99.
    Consolidates the 85existing provincial bus terminals with 60 bus companies operating approximately 7,368 buses into 4 common terminals (North, East, South and South East) NORTH CORRIDOR EAST CORRIDOR SOUTH EAST CORRIDOR SOUTH CORRIDOR 4
  • 100.
  • 101.
  • 102.
    ANNEX I Responding toNew Mobility Challenges in Quezon City
  • 103.
    3/5/2012 INTRODUCTION OF ELECTRICTRICYCLE IN QUEZON CITY 1
  • 104.
    3/5/2012 E-TRIKEPROGRAM OF THE DEPARTMENT OF ENERGY 1. DOE is pushing for the shifting to a more sustainable and indigenous sources of fuel. 2. DOE is partnering with LGUs to formulate a program to be able to help cities/municipalities acquire/adopt electric tricycles which  will benefit tricycle drivers who are earning below the minimum wage  will bring economic benefits from fuel savings or avoided cost on imported oil  will have potential positive impact on the environment which will also bring positive impact on the health of the people 3. The “E-trike Rent-to-Own Program,” will be designed jointly by the LGUs, DOE, ADB and a government financing institution to be implemented nationwide. DOE PROPOSED LGU E -TRIKE RENT-TO-OWN PROGRAM E-Trike Lessor/Bank LGU Remits payment to DPOS-TRU GFI on agreed terms E-TRIKE PMO LGU - Coop E-TRIKE Pays E-TRIKE RENT DRIVERS daily for the duration of the loan 2
  • 105.
    3/5/2012 E-TRIKE DESIGNS WITH DIFFERENT SPECIFICATIONS The E-Trike Program is a sub- program under the Fuel Sustainable Transport Program (FSTP) of the Dept. of Energy POTENTIAL DEMAND FOR THE ENTRY OF E-TRIKE IN METRO MANILA No. of TC Franchise in NCR, 2011 Manila 2,535 Quezon City 24,684 Mandaluyong 3,833 Marikina 3,159 Pasig 8,445 San Juan 506 No. of TC Caloocan 14,750 Franchise, Malabon 6,460 NCR 2011 Navotas 1,850 Valenzuela 4,419 Pasay 3,103 98,028 Makati 4,262 Las Pinas 4,821 Paranaque 4,787 Muntinlupa 4,510 Taguig 4,404 Pateros 1,500 0 5,000 10,000 15,000 20,000 25,000 30,000 3
  • 106.
    3/5/2012 DEPT. OF ENERGY’S PROPOSED INITIAL LIST OF POLICIES/REGULATIONS/ORDINANCES FOR IMPLEMENTATION BY LOCAL GOV’T UNITS 1. Gradual phase-out of petrol-fed tricycles 2. Provision of incentives for E-Trike 3. Preferential franchise/route for E-Trikes 4. Exemption from number coding scheme 5. Readiness to set-up E-Trike related businesses 6. Others Pilot Test ) (ELECTRIC TRICYCLES -T OR E RIKES 20 E-TRIKES (LITHIUM-ION BATTERIES) 10 Tricycles 10 Tricycles • Price of e-Trike (more than $1,000) • Full charge range 40-50 km • Full charge range 80-100 km • 3 kWh battery (B units) • 6 kWh battery (A units) • Will use public street charging • Overnight 8-hour charge at home • Fast charging in about 30 min 4
  • 107.
    3/5/2012 Battery Choices Lead Acid Pilot Test $800 Life: 200 charges 140 kg slow-charge only 72% lighter Lithium Ion $1,500 Life: 2,000 charges 40 kg slow and fast-charge DAILY FUEL SAVINGS (DESKTOP STUDY ASSUMPTIONS) Base Case: E-Trike: for every 100 km Assumptions: Assumptions: about 20 km per kWh 20 km per Liter 5 liters for 100 km 50 Peso per liter P200 5 kWh for 100 km 10 Peso per kWh >$5 or Peso 250 >$1 or Peso 50 5
  • 108.
    3/5/2012 RANGE RESULTS (“CONTINUOUS" RUNNING USING LITHIUM ION BATTERIES) B4: 62.21 km 3 KWh battery B7: 41.89 km 3 KWh battery A2: 90.33 km 6 KWh battery A1: 72.53 km 6 KWh battery Antipolo – Test Drive 6
  • 109.
    3/5/2012 TRANSFORMATION The project is about creating a new local industry and local employment AND Promotion of a healthful and balanced ecology TRANSFORMATION THROUGH ENERGY EFFICIENT ELECTRIC VEHICLE SYSTEMS – DELIVERING AN END-TO-END INFRASTRUCTURE SOLUTION 100,000 electric tricycles Cost $400.0 million Electricity Demand Savings: $185 million per year (peak-time charging) (500,000 liters/ day  $500,000 / day) Demand: 6-60 MW peak Avoided CO2 emissions Energy: 300,000 MWh • 400,000 tons per year Emissions: 160,000 tons 7
  • 110.
    3/5/2012 OUTPUT OF THEPROJECT  Complete e-Trike units delivered to LGUs with standard 3-year warrantee  Battery supply, installation, leasing and support infrastructure established  Efficient motor supply chain created  Public Charging stations installed in selected areas TARGETS (MINIMUM) By December 2012, at least:  2 reputable motor suppliers;  2 internationally reputable battery suppliers; By December 2013, at least:  6 e-Trikes suppliers with • 3 internationally reputable service support; and battery suppliers; and  7,000 e-Trikes operating • 15,000 e-Trikes operating By December 2014, at least: By December 2016, at least: • 500 locally made charging • 100,000 e-Trikes operating stations installed; and • 50,000 e-Trikes operating 8
  • 111.
    3/5/2012 MANAGEMENT OF THE OPERATION OF COMPLETELY BUILT ELECTRIC TRICYCLES DONATED BY ADB TO MANDALUYONG CITY KEY STAKEHOLDERS COMPETITIVE ADVANTAGES OF THE USE OF E-TRIKE COMPARED TO CONVENTIONAL 1. The Asian Development Bank TRICYCLE AS RECOGNIZED BY THE CITY OF As The Donor/Source Of MANDALUYONG Financing 2. Mandaluyong City As The 1. It is environment-friendly alternative. Operator 2. It is relatively more spacious. 3. Selected Individual Driver- beneficiaries 3. Does not require changing of oil. 4. Passsengers 4. Use of E-trikes is expected to be cheaper. 5. It is expected to increase the environmental awareness in the city. 6. It is expected to significantly lessen air and noise pollution. 7. Has available strategic charging stations. 9
  • 112.
    3/5/2012 COMPLETELY-BUILTE-TRIKE UNIT DONATED BY THE ADB DRIVERS AREA/FRONT LITHIUM-ION 3 KILOWATT MOTOR PANEL BATTERY SIMPLE COMPARISON BETWEEN A STANDARD TRICYCLE AND E-TRIKE AREAS OF COMPARISON CONVENTIONAL TRIKE ELECTRIC TRIKE ACQUISITION COST P 80,000.00 cash or P 200,000.00 P 175,000.00 installment for (approximately) 3-5 years NO. OF PASSENGERS 3-4 people 6-8 people max @ P 7.50/passenger @ P 7.50/passenger EXPECTED LIFE 7 years will full Battery Life IN YEARS maintenance 5.5 years/11 years COST OF FUEL* P 250.00/8 hours/day or P 45.00/6-8 hours/day or (8-10 HOURS) P 7,500.00/month or P 1,350.00/month or P 90,000.00/year P 16,200.00/year BOUNDARY COST P 150.00 P 150.00 POTENTIAL GROSS P 800.00 (approx.) P 1,600.00 (approx.) INCOME/DAY POTENTIAL NET P 400.00 (approximate) P 1,405.00 approximate INCOME/DAY** (P 146,000.00 per year) (P 512,825.00/year) * An E-Trike user may be able to save P 205.00/day or P 6,150.00/month or P73,800.00/year , which for regular tricycle drivers normally spend more for gasoline ** Less fuel/electric expenses and boundary cost. Tricycles Operational/Repair Expenses are not included 10
  • 113.
    3/5/2012 SUGGESTED E-TRIKE ACQUISITION-LIVELIHOOD PROGRAM (RENT-TO-OWN-PROGRAM) by Mandaluyong City OPERATIONS BOUNDARY (In 8 hours/day) Option 1 Option 2 P 150.00 per day P 350.00 per day In 30 Days / Month 4 years 1.5 years Operations In 24 Days / Month 5 years 2 years (6 days a week)  In 30 days operation, E-Trike drivers will own the unit in 4 years for P 150.00 per day boundary/payment (Option 1) or 1.5 years for P 350.00 per day boundary/payment (Option 2).  In 24 days operation, E-Trike drivers will own the unit in 5 years for P 150.00 per day boundary/payment (Option 1) or 2 years for P 350.00 per day boundary/payment (Option 2). QUEZON CITY DESIGN ELECTRIC TRICYCLE 11
  • 114.
    3/5/2012 THE POSSIBLE WAY OF THE ENTRY OF E-TRIKES IN QUEZON CITY TO BE ABSORBED BY THE TRICYCLE SECTOR IS THROUGH REPLACEMENT/SUBSTITUTION REPLACEMENT/SUBSTITUTION of existing gasoline-fed tricycles with franchises with COMPLETELY-BUILT ELECTRIC TRICYCLE UNITS is open to any of the following conditions:  Old and dilapidated 2-stroke and 4-stroke tricycle units  Individual Franchise Holders who are willing to replace their existing tricycle unit/s with electric tricycle/s  Selection of PILOT TODAs for the Initial Implementation of the “Rent-to-Own Program “ Number of Number of Tricycle Tricycle Association Unit With Franchise District I 29 4,736 District II-A (NDC) 38 6,150 District II-B (Main) 30 7,295 District III 19 2,668 District IV 34 3,835 Total 150 24,684 OPTIONS ON THE PROPOSED ACQUISITION OF E-TRIKE UNITS AND DISPOSAL OF OLD WITHDRAWN UNITS 1. Acquisition of E-trike units through financing options. 2. Trade-in of old tricycles with franchise for a new E-trike vehicles.  The old tricycle unit shall be bought by the City Government and the amount shall serve as downpayment for the E-Trike.  The City Government shall exercise all options in the disposal of the old tricycle units to recover the amount.  The old tricycle units bought by the City Government may be donated to provincial municipalities where the beneficiaries are farmers who may use the unit to transport their farm goods to the market.  The old tricycle units bought by the City Government may be donated to Sister Cities for their utility use. 3. Surrender of sidecar of tricycle unit with franchise for a new E-Trike vehicle.  All withdrawn For-Hire units must be converted into a single motorcycle unit through an undertaking. The sidecars are to be surrendered and assessed by the City Government for its depreciated value and may serve as down payment for the electric tricycle.  Withdrawn tricycle units which are converted into single unit as private classification shall no longer be fitted with sidecar and should not operate as For-Hire unit. 12
  • 115.
    3/5/2012 1. Gradual replacementand phase out of old petrol powered tricycles in five (5) years time.  Pursuant to the Philippine Clean Air Act, the Quezon City Government plans to convert all gasoline-powered For-Hire tricycle units operating in the City into Electric Tricycles by 2016 through a legislative measure.  In line with the replacement to E-Trike is the withdrawal of all gasoline-powered tricycle units from all TODAs in Quezon City.  No tricycle unit shall be allowed to operate as For-Hire in the City except electric tricycles. 2. Legislative measures should be formulated on the entry of and the promotion and sustainability of E-trikes in Quezon City. THANK YOU! 13
  • 116.
    ANNEX J SMART Programand New Mobility Initiatives of the University of Michigan
  • 117.
    3/5/2012 1. CONNECTING THE DOTS (for livability, sustainability, equity) 2. MOVING MONEY (innovation, access, jobs, enterprises) 3. MOVING MINDS (new way of looking at transport & cities) Susan Zielinski, SMART, University of Michigan. January 30, 2012, Manila Philippines LIVING LABS: Bangalore Beijing Cape Town Chennai Cochin Detroit Region Fairfax Los Angeles Manila Mexico City Mystic Pasadena Portland Seattle Shanghai Washington DC Lisbon / Coimbra / Porto etc… Connecting the Dots; Moving Money; Moving Minds RESEARCH, EDUCATION, TECH TRANSFER: ACCELERATE IMPLEMENTATION 1
  • 118.
    3/5/2012 PARTNERS & SPONSORS: National Science Foundation Center for South Asian Studies Transportation Research Board Rockefeller Foundation Mott Foundation FIA Foundation Alcoa Foundation Ford Motor (redefining) US Environmental Protection Agency Cisco Systems IBM Federal Highway Administration U.S. Department of Education CEO’s for Cities City Connect Chennai Confederation of Indian Industry etc… Why DID the chicken Cross the Road? 2
  • 119.
    3/5/2012 PURPOSE: Meet Needs - ACCESSIBILITY Live Love Work Play Other? Mobility* Technology * Proximity (a la Texas Transportation Mobility Institute) Transportation Land- Travel Capacity Use Demand Expansion Planning Management 3
  • 120.
    3/5/2012 (North America-wide comparative study) New Innovation Opportunitites Accessibility ENDS MEANS: New Mobility Mobility Proximity Connectivity BELLY OF THE BEAST ---- Transportation = Cars (everything else it extraneous) 4
  • 121.
    3/5/2012 Organ Donation Pledge I, ____________ (full name) wish to pledge the following organs ________________________ should I die as a result of this presentation. Date_______ Signature _____________________. Date_______ Signature of witness _____________. In case you should die as a result of this presentation, please keep this completed organ donor form in your wallet. “CAPTIVE” “Transportation Disadvantaged” 5
  • 122.
    3/5/2012 Transportation = cars (assumingtransportation is necessary) Therefore: CARS ARE NECESSARY THEREFORE: to improve on transportation… ??? 6
  • 123.
    3/5/2012 LANGUAGE • Captive • Transportation Disadvantaged • Alternative modes (women alternative men) • Public transport cost (vs. investment) • TDM (sacrifice) • “Side” walks • Road closings (vs. openings) • Car use reduction (vs more options) Qualities of New Mobility: …Like the Ideal Life’s Partner …  Multi-talented  Sexy  Clean  Innovative  Connected  Saves money  Integrated  Socially equitable  Smart  Service-oriented  Tech savvy  Creates jobs  Sophisticated  Caters to your needs  Confers status  Convenient  Accessible to all  Other? 7
  • 124.
    3/5/2012 …as Thomas Friedman might say … TRANSPORTATION IS FLAT OPEN SOURCE, MULTI-MODAL, MULTI-SERVICE, IT ENHANCED USER FOCUSED, SOCIALLY EQUITABLE, AESTHETIC LIVABLE WHOLE SYSTEMS TRANSPORTATION TRANSLATION: More Choices; More Connected Choices (New Mobility) EMERGING GLOBAL NEW MOBILITY INDUSTRY TO SUPPLY IT The current value of New Mobility markets can be measured in the billions of dollars.”Building a New Mobility Industry Cluster in the the Toronto Region” (MTE & ICF) RESULT: Almost all transport has at least an urban component CONTEXT: URBANIZATION From 50% - 2/3 by 2025; 81% in US; 90 % world economy Coming years: At least 35 cities more than 10 million 8
  • 125.
  • 126.
    3/5/2012 BRT went viral -- worldwide More than 83 Over 40 in North America alone ZIPCAR: Wheels When You Need Them services FRACTIONAL USE: AUTO RICKSHAWS, TAXIS & COMMUNAL CABS, INTERMEDIATE VEHICLES, CARSHARE, BIKE SHARE, SOCIAL NETWORKING, SLUGGING 10
  • 127.
    3/5/2012 new technology wayfinding; shared use; fare payment; traffic management; security etc. Design & new infrastructure 11
  • 128.
    3/5/2012 New modes /modal enhancements 12
  • 129.
  • 130.
    3/5/2012 VEOLIA Video CONNECTIVITY/OPTIMIZATIO CONNECTIVITY / OPTIMIZATION N (both energy & time) • spatial * • spatial / physical • service (use vs. own) • technological (wayfind; fare pay; traffic manage; security) • economic (revitalize; save $; create jobs; boost business) • institutional & policy (public private innovation) • cultural / psychological (moving minds) 14
  • 131.
    3/5/2012 GAME CHANGE:SEAMLESSLY CONNECTED OPTIONS LEAPFROG: Straight to Next Generation Whole Systems Design & Build - spatial connectivity supported by New Technologies and PPI NEW MOBILITY GRID: More Choices, More Connected The Next Infrastructure; The Next Industry Cluster Transportation Meetings 0:00 1:40 1:50 2:00 Agenda: WHAT IS NOT WORKING Solutions Laundry List Quick attempts at prioritization Adjourn Attendees: Usual Suspects 15
  • 132.
    3/5/2012 A heart? Alung? Pituitary gland? Your choice What is better? What is the silver bullet? I only use my heart I’m too rich and powerful to use my capillaries 16
  • 133.
    3/5/2012 CONNECTIVITY/OPTIMIZATION IS THE NEW SILVER BULLET ROLLING OUT THE GRID: 4 STEPS (public-private innovation) 1. CONVENING – The Crucial & Often Under-Rated First Step (not just the usual suspects – public private innovation 2. MAPPING – An Engaging and Tangible Catalyst for Action 3. PILOTING & ROLL-OUT – Start with Hologram for Wider Spread Roll- Out 4. MOVING MINDS – Speak a new language (Rumi, Philip K. Dick) 5. NETWORK (SMART network – “twinning” for shared genius) 17
  • 134.
    3/5/2012 CONVENING MAPPING and PILOTING Washington, DC Ann Arbor, Michigan 18
  • 135.
    3/5/2012 CHENNAI: Linking design, value capture, cycles, auto rickshaws, pedestrians, local business & new technologies (e.g. Mapunity, Cisco, Ashok, thru CII) COCHIN (quiet leapfrog) Links train, metro, bus, ferry, auto, taxi, parking, 2 wheelers & cycles Linked to commercial, entertainment, tourism, lifestyle 70% of people need not enter city (larger hubs gateways to grid of smaller hubs) Transform economy & lifestyle Sustainable – supported by real estate elements 19
  • 136.
    3/5/2012 Mexico City CAPE TOWN – entrepreneurial ventures, way-finding, workplaces, public-private innovation, moving minds 20
  • 137.
    3/5/2012 Moving Minds Did Philip K.Dick predict or shape the future? SYSTEM OF SYSTEMS: CHANGES THE GAME Connects Mode Service Product Technology Design  Door to Door (feeds trunk, focused on user)  Scalable / incremental / ALL YESES / induces demand  For all shapes & sizes of communities & regions  Short term / long term (not land use / policy dependent)  Appealing (design, cool status) & Safe & Equitable  Resilient & Robust (to climate / geopolitical challenges)  Business, Innovation, Job Opportunities (New Mobility Industry Cluster Multi-Billion $) 21
  • 138.
    3/5/2012 NEW MOBILITY ECONOMIC BENEFITS Saves Money Creates Jobs Boosts Business Revitalizes Local Economy TELECOMMUNICATIONS & WIRELESS CLEAN ENERGY E- BUSINESS & NEW MEDIA TRANSPORTATION INFORMATION EQUIPMENT TECHNOLOGY FINANCIAL SERVICES, TOURISM BAN KING & INVESTMENT NEW MOBILITY & RETAIL INDUSTRY TRANSPORTATION GEOMATICS OPERATIONS & SERVICES REAL ESTATE CONSTRUCTION, GOODS MOVEMENT PLANNING & & SUPPLY CHAIN OPERATIONS INTELLIGENT MANAGEMENT TRANSPORTATION SYSTEMS 22
  • 139.
  • 140.
    3/5/2012 NEW ROLES (AND OPPORTUNTIES) PUBLIC SECTOR – incentives to connectivity / systems convening beyond the usual players / implementing, integrative frameworks / platforms to boost innovation & implementation. MOBILIZATION PRIVATE SECTOR – public-private innovation (action affects policy), new products, marketing New Mobility culture PUBLIC PRIVATE INNOVATION ACADEME – new models / tech transfer based on real world contexts, understanding & advancing solutions (not just problems). ACCELERATING IMPLEMENTATION NGO’s – informing / new approaches, partnering, engaging constituencies / implementing METRO MANILA What Dots Are Already Connected? What dots can be easily connected? What needs to be added (locally and system wide)? What benefits can be reaped? Social, ecological economic? Who else should be at the table? What policies, business models, marketing approaches can help address the challenges? When does the fun start? 24
  • 141.

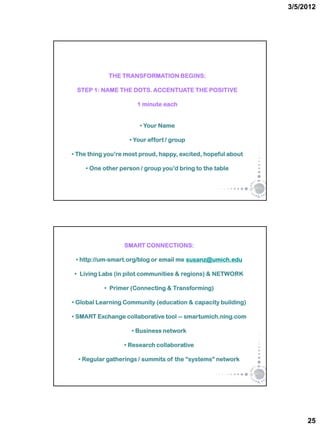

    3/5/2012 THE TRANSFORMATION BEGINS: STEP 1: NAME THE DOTS. ACCENTUATE THE POSITIVE 1 minute each • Your Name • Your effort / group • The thing you’re most proud, happy, excited, hopeful about • One other person / group you’d bring to the table SMART CONNECTIONS: • http://um-smart.org/blog or email me susanz@umich.edu • Living Labs (in pilot communities & regions) & NETWORK • Primer (Connecting & Transforming) • Global Learning Community (education & capacity building) • SMART Exchange collaborative tool -- smartumich.ning.com • Business network • Research collaborative • Regular gatherings / summits of the “systems” network 25
  • 142.
    ANNEX K Updates/ Insightsfrom the Rockefeller Foundation
  • 143.
    3/5/2012 Why did the chicken cross the road? Why do we need transportation anyway? Seven Needs 1. It takes us where we want to go 2. It takes us when we want to go 3. It is a good use of our time 4. It is a good use of our money 5. It respects us with the level of safety, comfort and amenity it provides 6. We can trust it 7. It gives us the freedom to change our plans Adapted from Jarrett Walker’s “Seven Demands of Transit” in Human Transit: How clearer thinking about Public Transit can Enrich our Communities and Our Lives, Island Press, 2011. 1
  • 144.
    3/5/2012 To be a“lively, attractive, safe and sustainable city, [a city] must be sweet to its pedestrians, sweet to its cyclists.” Jan Gehl: Making Cities for People 2
  • 145.
    ANNEX L How responsive is Metro Manila ’s Public Transport System to the Needs of the Poor and Vulnerable Sectors? Insights from a Mobility Mapping Case Study of Metro Manila
  • 146.
    3/5/2012 HowMapping of the Public Transportation System can Respond to the Needs of the Poor and Vulnerable Sectors JUN T. CASTRO, Dr. Eng. 31 JANUARY 2012 INTRODUCTION  3 Keywords: Mapping + Public Transport + Poor/Vulnerable  Geographic Information System (GIS) mapping greatly enhances any planning study. Its graphical map-based interface, enhances data management and input capabilities.  Several studies have used GIS for public transport planning, as well as urban poor community planning  But limited studies on relationship of public transport and poor communities using mapping techniques 1
  • 147.
    3/5/2012 RESEARCH PROJECT GOALS Using GIS, identify, map and assess public transportation supply (modes, routes & facilities)  Identify gaps in the data sets or barriers to access these data sets  Assess the mobility of the urban poor and vulnerable sector in relation to transport supply  Identify transport-related improvements in infrastructure and services that will benefit urban poor communities in the case study areas TASKS AND ACTIVITIES  Conduct secondary and primary data gathering  Identify and formulate alternative mapping strategies for primary data collection  Develop database of public transport hubs (i.e. bus, FX/GT Express, PUJs, tricycles), public transport and pedestrian networks  Identify transport hubs (formal and informal) connecting urban poor communities in the study areas  Map out public transit networks in the study areas 2
  • 148.
    3/5/2012 EXPECTED OUTPUT  Documentationof process for generating, encoding, storing, sharing, and displaying user-friendly maps of public transport hubs/terminals:  Using internet, i.e. open source mapping  Using GIS  Using interactive platforms  GIS Database generated  Decision maps to meet the needs of poor/vulnerable sectors in the case study areas METHODOLOGICAL FRAMEWORK Review of Database Spatial Publishing of Data Development Analysis Results • Existing • Buffering/Proxi • PT hub maps • PT Supply database mity analysis • PT network • PT Demand • Crowd-sourcing • Overlay analysis maps • Informal • Field surveys • Network • Pedestrian Settlements • Questionnaire analysis walkways • Validation, etc. • Decision maps 3
  • 149.
    3/5/2012 REVIEW OF DATA Spatial mapping on public transport and pedestrian infrastructure (PT hubs (nodes), PT routes (links), Pedestrian facilities)  MMUTIS (Metro Manila Urban Transport Integration Study), JICA (1999)  MMUTSI (Metro Manila Urban Transport System Information), JICA (2005)  MMPTS (Mega Manila Public Transport Study), JICA (2007)  MMPTPSS (Mega Manila Public Transport Planning Support System Study), JICA (2012)  Informal settlements  Urban Poverty Morphology Project, Manila Observatory and Urban Research Consortium (2000) DATABASE DEVELOPMENT CROWD-SOURCING/SMART MAPPING Discussed/To be discussed by: Mr. JayR Cordova in the AM session, and Ms. Susan Zielinski in the PM session 4
  • 150.
    3/5/2012 DATABASE DEVELOPMENT VALIDATION OF COLLECTED PHOTO DOCUMENTATION DATA THROUGH FIELD SURVEY DATABASE DEVELOPMENT GIS MAPPING  effective way to visualize data and perform spatial analysis to identify relationships between map layers.  validated data are digitized or converted into GIS data format (e.g., kmz to shp) 5
  • 151.
    3/5/2012 SPATIAL ANALYSIS  Proximity Analysis/Buffering  involves creation of areas around a geographical entity based on a measurement of distance  Overlay analysis  map layers are combined to form a new layer that provides new information derived from the attributes of the input layers  Maps are the basis of both spatial and non-spatial decision- making PUBLISHING TO OPEN SOURCE MAPS  Validated datasets to be published to open source maps (e.g. openstreet map, google earth map, etc.) 6
  • 152.
    3/5/2012 SAMPLE TRANSITMAP STUDY AREA  Metro Manila to map out Public Transport terminals and NORTH EDSA/AGHAM MATANDANG BALARA PAYATAS routes  Crowd-sourcing activity  Existing database from past studies (i.e., MMUTIS, MMPTS, MMPTPSS)  Quezon City for case studies of poor/vulnerable communities 7
  • 153.
    3/5/2012 SOME PRELIMINARY RESULTS NUMBEROF TERMINALS AND ROUTES FOR BUSES (1983/1996) MODES ITEM SERVICE AREA 1983 1996 1996/1983 BUS No. of MM Intracity 197 150 0.76 Routes No. of Inside MM 121 35 0.29 Terminals Estimated MM Intracity 5,900 12,900 2.19 No. of Operating Units Source: 1983 JUMSUT & 1996 MMUTIS SOME PRELIMINARY RESULTS NUMBER OF TERMINALS AND ROUTES FOR JEEPNEYS (1983/1996) MODES ITEM SERVICE 1983 1996 1996/1983 AREA JEEPNEY No. of MM Intracity 780 490 0.66 Routes No. of Inside MM 184 210 1.14 Terminals Estimated MM Intracity 35,000 69,700 1.96 No. of Operating Units Source: 1983 JUMSUT & 1996 MMUTIS 8
  • 154.
    3/5/2012 SOME PRELIMINARY RESULTS NUMBER OF TERMINALS AND UNITS FOR TRICYCLES (1983/1996) MODES ITEM SERVICE 1983 1996 1996/1983 AREA TRICYCLE No. of Inside MM 276 640 2.32 Terminals Estimated MM Intracity 17,000 60,700 3.57 No. of Operating Units Source: 1983 JUMSUT & 1996 MMUTIS SOME PRELIMINARY RESULTS JEEPNEY AND TRICYCLE TERMINALS Source: JICA 1999 MMUTIS 9
  • 155.
    3/5/2012 SOME PRELIMINARY RESULTS TRICYCLETERMINALS IN QUEZON CITY Total Number of TODAs = 150 District 1 = 29 District 2 = 68 District 3 = 19 District 4 = 34 No. of Units with Franchise District 1 = 4,727 District 2 = 13,542 District 3 = 2,668 District 4 = 3,863 Source: Quezon City LGU SOME PRELIMINARY RESULTS PARTIAL MAPPING OF PT TERMINALS IN NORTH EDSA AREA Informal settlement 10
  • 156.
    3/5/2012 CONCLUDING REMARKS Database and mapping can be useful in responding to the needs of the poor and the vulnerable groups  GIS can be used as a tool to identify improvements in PT system  Database development (using traditional and appropriate technology in data collection)  Conversion of database to GIS (digitization, data conversion, etc.)  Spatial analysis  Application to planning (e.g., PT and pedestrian improvements, etc.)  Whether poor is well served by PT system and pedestrian networks  Whether transportation levels of service is above acceptable levels, etc.  Decision maps to help planners and general public  Seamless pedestrian walkway maps, PT service maps, etc. THANK YOU FOR YOUR ATTENTION Jun T. Castro, Dr. Eng. Associate Professor UP School of Urban and Regional Planning nujortsac@gmail.com 11
  • 157.
    ANNEX M Case Studieson the Mobility Characteristics, Cost and Issues of the Poor and Vulnerable Groups
  • 158.
    Ateneo School ofGovernment 3/5/2012 Catalyzing New Mobility in Cities: The Case of Metro Manila Project Launching Ateneo de Manila University January 31, 2012 with generous support from Case Studies on the Mobility Characteristics, Costs, and Issues of the Poor and Vulnerable Groups Randolph D. Carreon, MATP, BSEcon Transport Economist 1
  • 159.
    Ateneo School ofGovernment 3/5/2012 Objectives of the Study • The Study aims : – to understand the MOBILITY CHARACTERISTICS, COSTS AND ISSUES of the poor and vulnerable groups. • Specifically, the Study aims to: – establish the travel demand patterns of the poor and vulnerable groups; – look qualitatively into the efficiency of the public transport system vis-à-vis the needs of the poor and the vulnerable groups; – estimate the cost of mobility of the poor; – estimate the actual and desired cost of transport of those within the vulnerable groups; and – examine other non–quantifiable costs, if any, incurred by the vulnerable groups Who are the Poor and the Vulnerable Groups? For purposes of this Study: – The “Poor” are those living within “colonies” of informal settlers. • Three (3) informal settler colonies in Quezon City as case study areas: a. Purok Centro, Barangay Old Balara b. Along Agham Road (North Triangle) c. GK Village in Barangay Payatas – The “Vulnerable Groups” will include (i) PWDs, (ii) Senior Citizens, (iii) Women and Children, and (iv) Business Process Outsourcing (BPO) workers. 2
  • 160.
    Ateneo School ofGovernment 3/5/2012 Data Gathering Methodology • Household interviews in the three (3) informal settlement areas. Approximately 100 HH respondents per area. • The initial findings, based on the interviews, will be validated during a Small Group Validation Workshop (Public Consultation) in each of the area. • Individual interviews will be conducted with BPO workers. • Individual Interviews, Key Informant Interviews (KIIs) and Focused Group Discussions (FGDs) will be conducted with the other vulnerable groups. • Secondary data will also be collected. Project Update Activity Inclusive Dates Inception Meeting 27 October 2011 Preparatory Works Nov - Dec 2011 Coordination with the Mid – January 2012 to Case Study Areas present HH Interviews 14 – 20 January 2012 Public Consultation 27 January 2012 Project Launch (including 31 January 2012 Presentation of Initial Findings) Other Data Gathering Feb – Mid March 2012 Activities Completion of Analyses Feb – March 2012 Final Report End – March 2012 3
  • 161.
    Ateneo School ofGovernment 3/5/2012 PROJECT ACTIVITIES AND INITIAL FINDINGS Household Interviews Public Consultation 4
  • 162.
    Ateneo School ofGovernment 3/5/2012 General Findings • No of HH in Purok Centro, Brgy Old Balara: 414 • Average HH Size: 4.78 (say 5) • No of “From Home” Trips per Day: approx 1,000 • No of Total Person–Trips per Day: approx 20,800 Trip Purpose of “From Home” trips Modal Split (all person–trips) Walk 31.10% Own Bicycle 0.62% NMPT 0.16% 40% 34.37% Tricycle 19.13% 35% 31.10% 30% PUJeep 34.37% 25% 19.13% 20% FX 0.62% 15% 10% 8.09% 3.89% PUBus 8.09% 5% 0.62% 0.16% 0.62% 1.56% 0.16% 0.31% 0% Mass Transit 1.56% Private Vehicle 3.89% Taxi 0.16% School Service 0.31% 5
  • 163.
    Ateneo School ofGovernment 3/5/2012 Average Annual Income and Expenses With Rent No Rent With MV Without MV With MV Without MV Food 105,850.00 79,102.05 104,633.33 91,144.33 Rent and Utilities 102,700.71 49,835.31 45,933.85 41,680.65 Communication 6,067.74 8,162.01 14,796.54 6,871.30 Education 3,392.63 10,897.05 33,280.51 25,422.63 Medical Care 3,590.73 3,860.82 16,897.63 14,323.00 Recreation and Vices 14,369.23 13,741.70 31,763.08 7,183.10 Transport 16,897.59 21,905.56 31,541.11 25,753.70 Others 34,815.38 23,345.72 22,849.94 15,314.00 Total Annual Expenses 287,684.00 210,850.21 301,695.98 227,692.71 Average Annual Income 271,040.00 203,138.11 269,002.80 167,261.10 % of TC to AAI 6.23% 10.78% 11.73% 15.40% % of TC to Total Expenses 5.87% 10.39% 10.45% 11.31% Share of Transport Cost to Total Annual Expenses 350.00 300.00 250.00 Thousands 200.00 150.00 100.00 50.00 0.00 With Rent - With MV With Rent - Without MV No Rent - With MV No Rent - Without MV Transport Food Rent and Utilities Communication Education Medical Care Recreation and Vices Others 6
  • 164.
    Ateneo School ofGovernment 3/5/2012 Breakdown of Annual Transport Cost With Rent No Rent With MV Without MV With MV Without MV Fuel (Own MV) 6,083.33 0.00 7,735.19 0.00 Registration and Maintenance(Own MV) 8,040.92 0.00 8,169.92 0.00 Fare (To Work) 2,773.33 10,905.56 8,996.00 14,430.00 Fare (To School) 0.00 4,500.00 6,640.00 7,857.03 Fare (To Market) 0.00 6,500.00 0.00 3,466.67 Total 16,897.59 21,905.56 31,541.11 25,753.70 Major Non-Monetary Cost: Safety 7
  • 165.
    Ateneo School ofGovernment 3/5/2012 Perceived Primary traffic availability of Mobility long travel congestion public 3% transport Problems time 2% vehicles 2% crowded public high transport vehicles transport 2% cost 91% Proposed Solutions (from Purok Centro) 1 work for additional income 2 lower fare 3 increase salary 4 walk Other Recommended Solutions: • Cooperation of motorists • limit number of passengers to vehicle's seating capacity • private vehicle reduction • provide efficient transport 8
  • 166.
    Ateneo School ofGovernment 3/5/2012 Thank You 9
  • 167.
    ANNEX N A PreliminaryInventory and Typology of Enterprise Models for Inclusive Mobility in Metro Manila: Of, By, and For the Poor and Vulnerable
  • 168.
    Ateneo School ofGovernment 3/5/2012 Catalyzing New Mobility in Cities: The Case of Metro Manila By: Ateneo Center for Social Entrepreneurship (ACSEnt) SDC Hall, Social Development Complex Ateneo de Manila University January 31, 2012 with generous support from Fashion Victim 1
  • 169.
    Ateneo School ofGovernment 3/5/2012 Research Goals & Objectives • Mobility challenges of the poor and vulnerable sectors; • Existing (emerging) transport / mobility related social enterprise opportunities in the transport sector; • Sustainable innovative ideas and business models on new mobility and transport-related social enterprises – high potential for scale and replication, prescribed new mobility features, benefitting the poor and the vulnerable sectors; • Prescribe features of new mobility social enterprise models and incentive programs; • Market barriers and enablers : o Policy o Economics o Socio-Cultural • New platform, resource centre and enabler of innovation for a socially inclusive mobility in the region starting with Metro Manila with generous support from Scope • Focus – Commercial and enterprise component of the transport and new mobility sector • Key variables and indicators for output delivery – Barriers – Enablers • Methodology – Qualitative – Quantitative • Related Literature – Case studies and reports – Journals – Others • Output: expected output / “input” process from the framework with generous support from 2
  • 170.
    Ateneo School ofGovernment 3/5/2012 Limitations • Case Study: Metro Manila – Sampling: Quezon City Area (with high- density urban poor population and vulnerable sector), near major transport hubs • Output – Templating and modelling, features of social enterprise new mobility – Not concrete business models – crowd sourcing with generous support from Expected Outputs • Mobility challenges of the poor and vulnerable • Existing mobility models • Emerging new mobility models – social enterprises • Social enterprise opportunities for the mobility (transport) sector that will purposively benefit the poor and vulnerable with generous support from 3
  • 171.
    Ateneo School ofGovernment 3/5/2012 Research Questions 1. What are the mobility challenges of the poor and the vulnerable sectors? 2. What are the existing mobility models? 3. What are the new mobility business innovations/approaches (including service models) that most effectively benefit the poor and vulnerable? 4. What are the barriers and enablers to implementation, replication and scaling up mobility innovations with generous support from Primary Considerations • Considerations for emerging new mobility sector: - Efficiency (time to get from point A to point B) - Cost (vulnerable/poor-friendly transport fare) - Environmental - Convenience and Safety - Human-centered design principle • Proximate demands and supply for new mobility mechanisms • Mechanisms, infrastructures, systems that can support the various needs and requirements of the new mobility consumers • Features of the new mobility system that will be convenient and helpful to the consumers • Incentives, principles, barriers and enablers with generous support from 4
  • 172.
    Ateneo School ofGovernment 3/5/2012 Linear Design Thinking 5
  • 173.
    Ateneo School ofGovernment 3/5/2012 Design *INPUT PROCESS *OUTPUT HUMAN-CENTERED Innovation Platform, Resource DESIGN PROCESS Enabler Center, *THROUGHPUT (DELIVERY) PROCESS BARRIERS / ENABLERS Design Possibilities Capacity Dev’t & Implementation Vulnerable Approaches SE Models/ Custom-fit sector- Design friendly mobility infrastructure design Monitoring and Sustainability Measures *OUTCOME Methodology • Data Gathering – Multimethodology: Mixed Approach Design (MADS) • Primary data gathering – Quantitative • Survey • Area sampling – Qualitative • Secondary data analysis and review of related literature • Focused group discussion • Interview with key informants • Community consultation • Validation and analysis – Triangulation methodology – Hybrid data gathering methodology: Human-centered Design (quanti-quali cross-validation approach) with generous support from 6
  • 174.
    Ateneo School ofGovernment 3/5/2012 Operational Variables & Definitions • Business model  depicts the rationale of how organizations identify key strategic variables and measures  blueprint for the organization’s business strategy  architecture of the organization that includes the core aspect of the business with generous support from Operational Variables & Definitions • Social entrepreneurship As an activity: the activities in which organizations engage to achieve socially-beneficial and inclusive objectives and pursue the mission through sustainable resource mobilization strategies with generous support from 7
  • 175.
    Ateneo School ofGovernment 3/5/2012 Operational Variables & Definitions • Social entrepreneurship As an approach/methodology: an innovative and system-changing approach in solving pervasive social problems through sustainable entrepreneurial practices with generous support from Operational Variables & Definitions • Social entrepreneurship As a business model: a business model where capabilities of the business, public and citizen sector are leveraged to deliver needed goods and services to marginalized populations such as the Base of the Pyramid (BoP) with the achievement of multiple bottomlines as the end goal. with generous support from 8
  • 176.
    Ateneo School ofGovernment 3/5/2012 Operational Variables & Definitions • Social enterprise In general: Social enterprises are organizations that engage in social-mission driven initiatives to address pervasive social problems and close this gap through an innovative, system- changing and wide-scale approaches. These are organizations that are involved in activities whose main stakeholders are the marginalized sector and come up with sustainable resource- mobilization strategies to achieve multiple bottomline goals. with generous support from Operational Variables & Definitions • Social enterprise By nature: Social enterprises can be identified as organizations whose social mission is consciously embedded within its structure, governance and core aspect of the business. The social gain is not just an “auxiliary” activity (such as CSR or community outreach missions) of the entire business operation, but rather embedded as integral to its business model and strategy with generous support from 9
  • 177.
    Ateneo School ofGovernment 3/5/2012 Operational Variables & Definitions • Social enterprise By social aims and outcomes: Social enterprises explicitly attempt to close the gap by providing innovative solutions to pervasive social problems that the public, private and traditional citizen-sector failed to address. with generous support from Operational Variables & Definitions • Social enterprise By stakeholder-focus: Social enterprises are organizations that are mainly focused on the marginalized sector such as those in the bottom of the pyramid (BoP), physically disadvantage, and so on, and create opportunities where these stakeholders are the primary consumers, market drivers or leadership base of the organization itself. with generous support from 10
  • 178.
    Ateneo School ofGovernment 3/5/2012 Operational Variables & Definitions • Social enterprise By leadership and sectoral-base: Social enterprises are led by individuals, groups or communities that are not main actors within the public or corporate sector. However, this particular social enterprise typology must not be misconstrued with its definition in terms of legal status. Social enterprises can be led by private individuals or groups as well as the citizen sector who have started the organizations as independent from government agencies and the traditional corporate business units. with generous support from Operational Variables & Definitions • Innovation As a process: innovation is the process by which unconventional ideas or ways of doing things are translated or created to achieve revolutionary systems-change As an outcome: is the result or by-product of a process that offers new systems, infrastructures and processes of doing things with generous support from 11
  • 179.
    Ateneo School ofGovernment 3/5/2012 Operational Variables & Definitions • Barriers / Enablers 1. Policy: standards and regulatory mechanisms 2. Economic: market model, supply-demand 3. Socio-cultural: human ecology, cultural anthropology, patterns of behavior, social context with generous support from Pre-test Data Gathering with generous support from 12
  • 180.
    Ateneo School ofGovernment 3/5/2012 Preliminary Findings • Key Mobility Challenges of the Poor and Vulnerable – Cost – Length of travel – Travel time – Challenges in terms of access to basic goods and services are not due to lack of transport modes, but in terms of the cost of goods itself (indirect influence due to cost of transport) with generous support from Preliminary Findings • Supply-demand study on transport/mobility products and services ICT Access Affordability with generous support from 13
  • 181.
    Ateneo School ofGovernment 3/5/2012 Preliminary Findings • Supply-demand study on transport/mobility products and services Information services Rank Information Average 1 Cost 1.96 • Most important information considered by travelers is the 2 Length of Time 2.75 cost of transportation. 3 Available Transportation 2.78 • Least considered is the service features available. 4 Direction 3.16 5 Safety Features 4.04 • Willingness to pay: average 6 Distance 4.22 price = Php 6.65 7 Others 5 8 Travel Route 6.16 with generous support from 9 Service Features 6.25 Preliminary Findings • Supply-demand study on transport/mobility products and services • Majority have difficulty in Frequency Percentage availing of healthcare (n = Services Difficult Easy Difficult Easy 20, 64.52%) and finding Food 9 22 29.03 70.97 employment (n = 18, Healthcare 20 11 64.52 35.48 58.06%). Clothing 12 19 38.71 61.29 • Primary issue: not in terms Employment 18 13 58.06 41.94 of inaccessibility directly Government Services 15 16 48.39 51.61 related to transport, but Sanitation 7 24 22.58 77.42 more in terms of actual cost Water 7 24 22.58 77.42 of goods Others 31 0.00 100.00 with generous support from 14
  • 182.
    Ateneo School ofGovernment 3/5/2012 Preliminary Findings Frequency Percentage Reasons Yes No Yes No • 24 (77.42%) Distance 13 18 41.94 58.06 attribute their Price (to costly to difficulty towards travel) 14 17 45.16 54.84 the cost of availing of these goods and Price (to costly to avail) 24 7 77.42 22.58 services. Access 12 19 38.71 61.29 Others 31 0.00 100.00 with generous support from Preliminary Findings • Existing and Emerging Mobility Models and Case Studies Recurring themes and features: • Sustainable transportation – sustainable targets – sustainable legislation for transportation and land coordination policies/ designs, inter and intra-agency collaboration approach, agency prioritization and allocation process • Energy efficient with generous support from 15
  • 183.
    Ateneo School ofGovernment 3/5/2012 Preliminary Findings • Existing and Emerging Mobility Models and Case Studies Recurring themes and features: • Multi-modal mobility • Multi-stakeholder approach • Human patterns of movement • Predictability of movement of goods and people • Minimizing cost with generous support from Preliminary Findings • Barriers and Enablers – Policy: uncoordinated, fragmented, unsustainable policy and regulatory frameworks do not offer support for the development of sustainable pro-poor mobility structures – Economics: current economic incentives are mostly private- sector biased, mobility models are designed not to cater to human needs but for achievement of bottomline profit – Socio-cultural: urban development and transport system designs in MM are out of sync with patterns of settlement, human ecology, consumer behaviors, unsustainable land and resource planning with generous support from 16
  • 184.
    Ateneo School ofGovernment 3/5/2012 17
  • 185.
    Ateneo School ofGovernment 3/5/2012 18
