Program Management ReviewSystems DeploymentJuly 13, 2011
Program Management Review
AEP Project Charter (Pete Gangl)

AEP Project Plan (Pete Gangl)

AEP Project Plan Cont. (Pete Gangl)

AEP 4 Blocker(Pete Gangl)

CPS  Program Charter– Robert Erickson

CPS  Program Charter (Robert Erickson)

CPS  Program Plan– Robert Erickson

CPS Risk Plan (Robert Erickson)

CPS 4 Blocker (Robert Erickson)

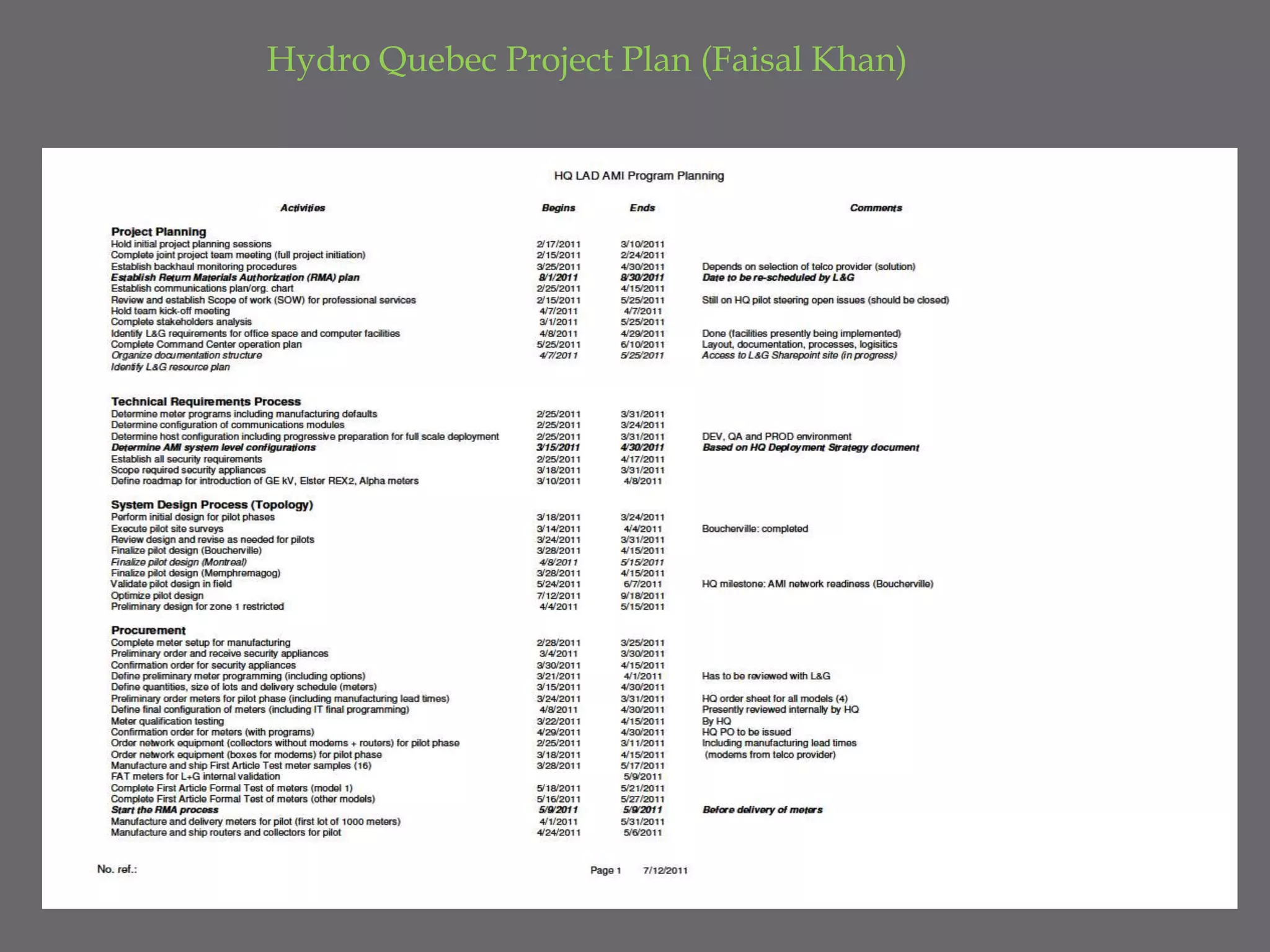

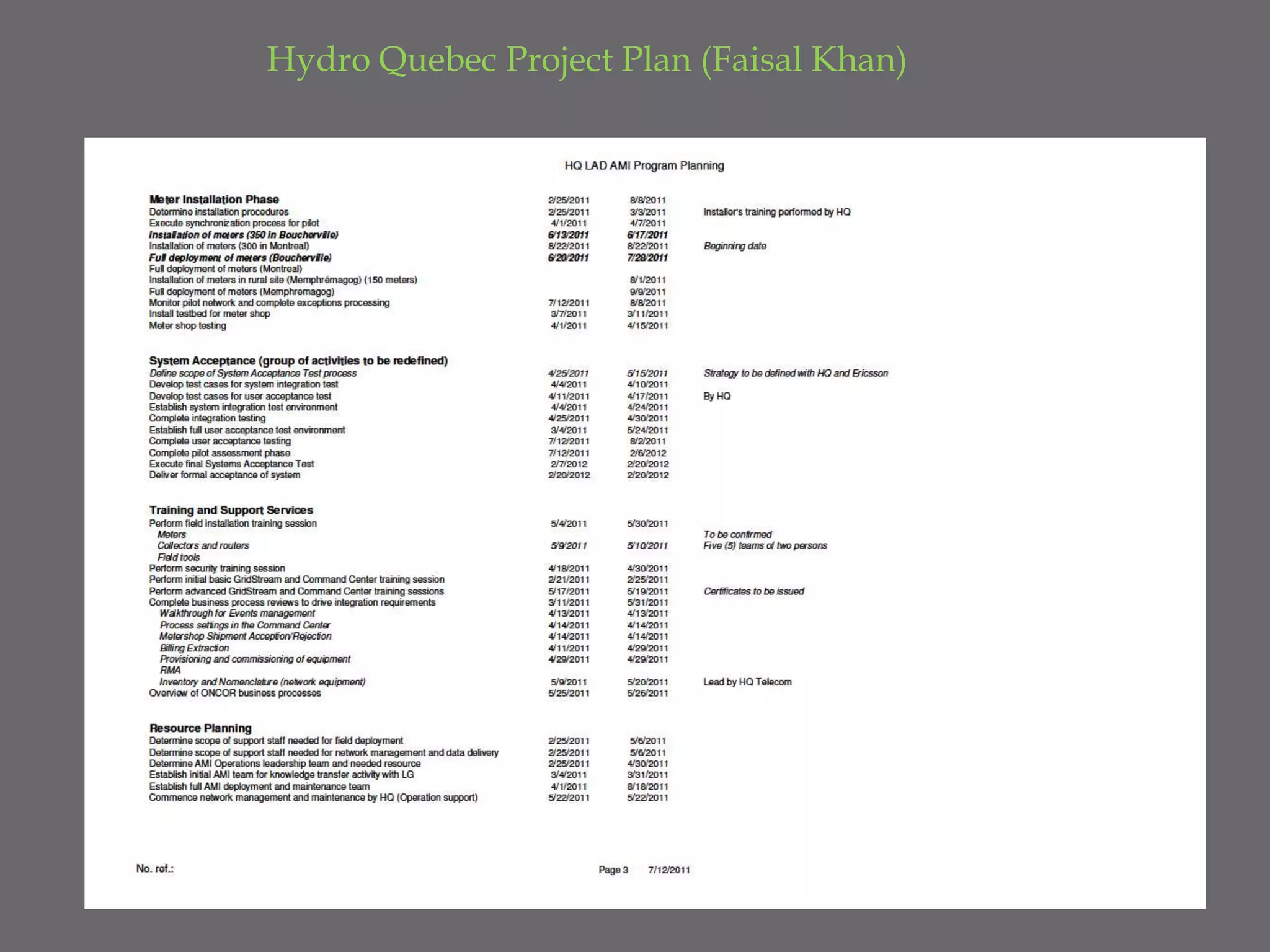

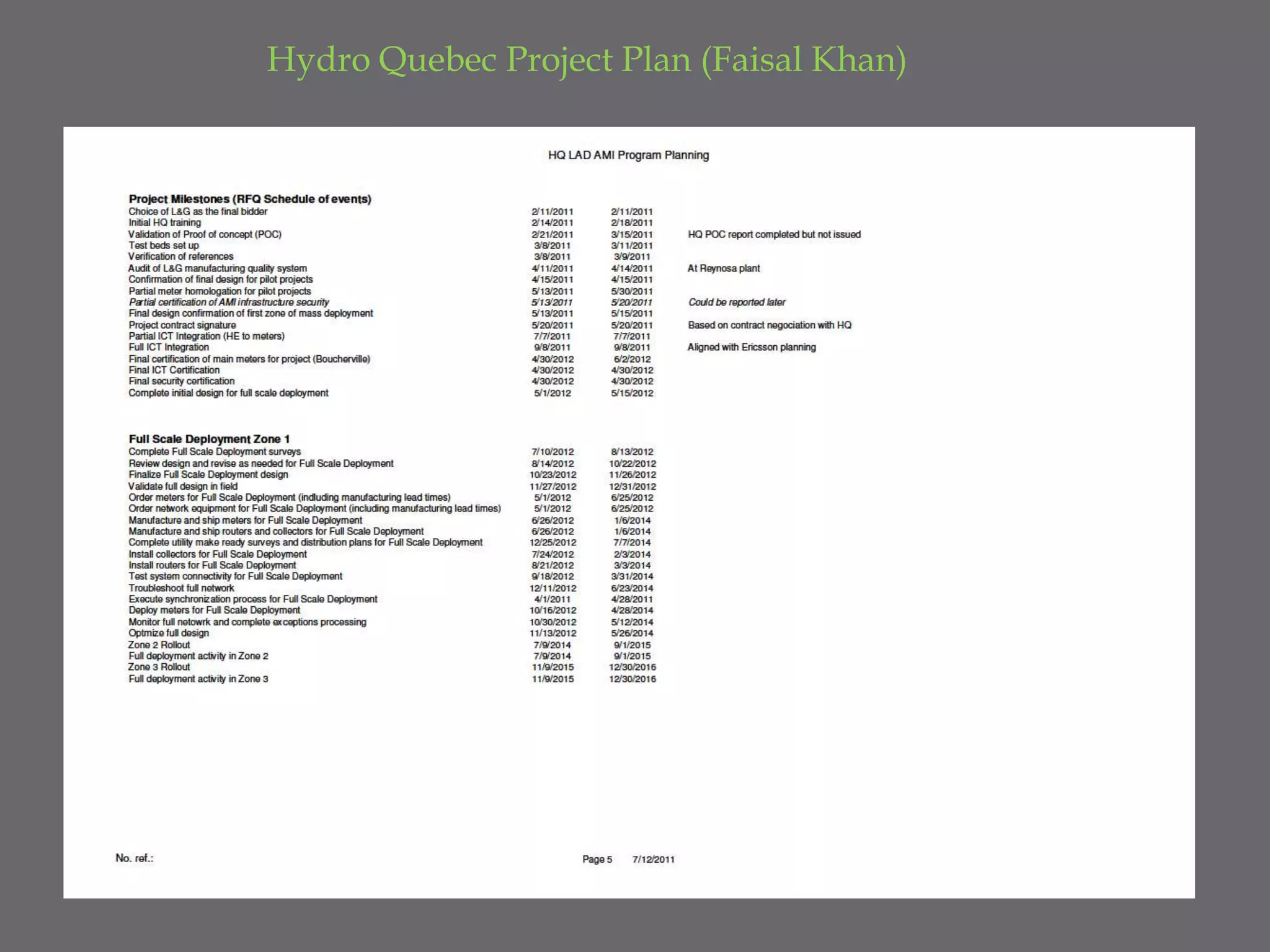

Hydro Quebec Project Plan (Faisal Khan)

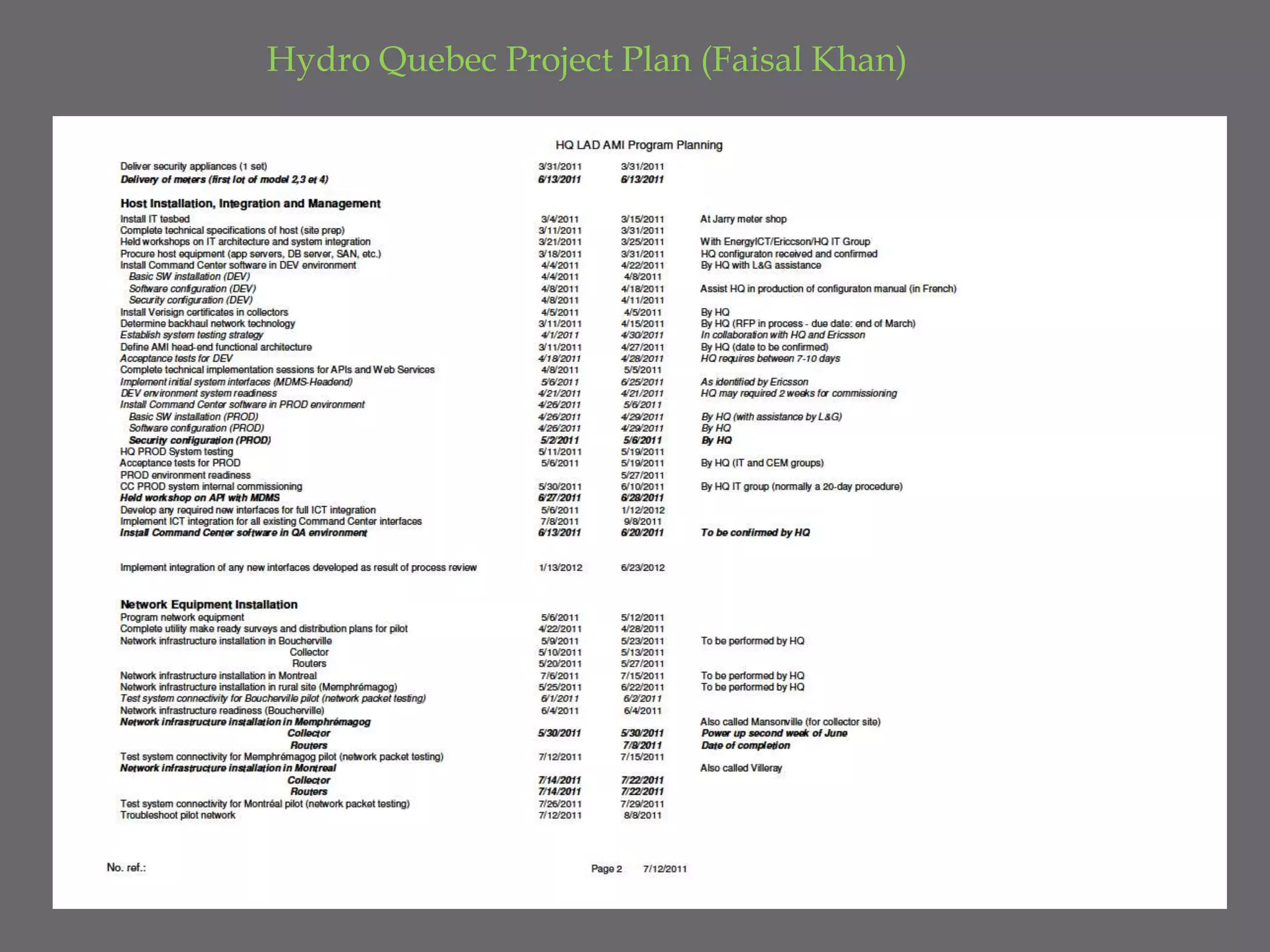

Hydro Quebec Project Plan (Faisal Khan)
Hydro Quebec Project Plan (Faisal Khan)
Hydro Quebec Project Plan (Faisal Khan)

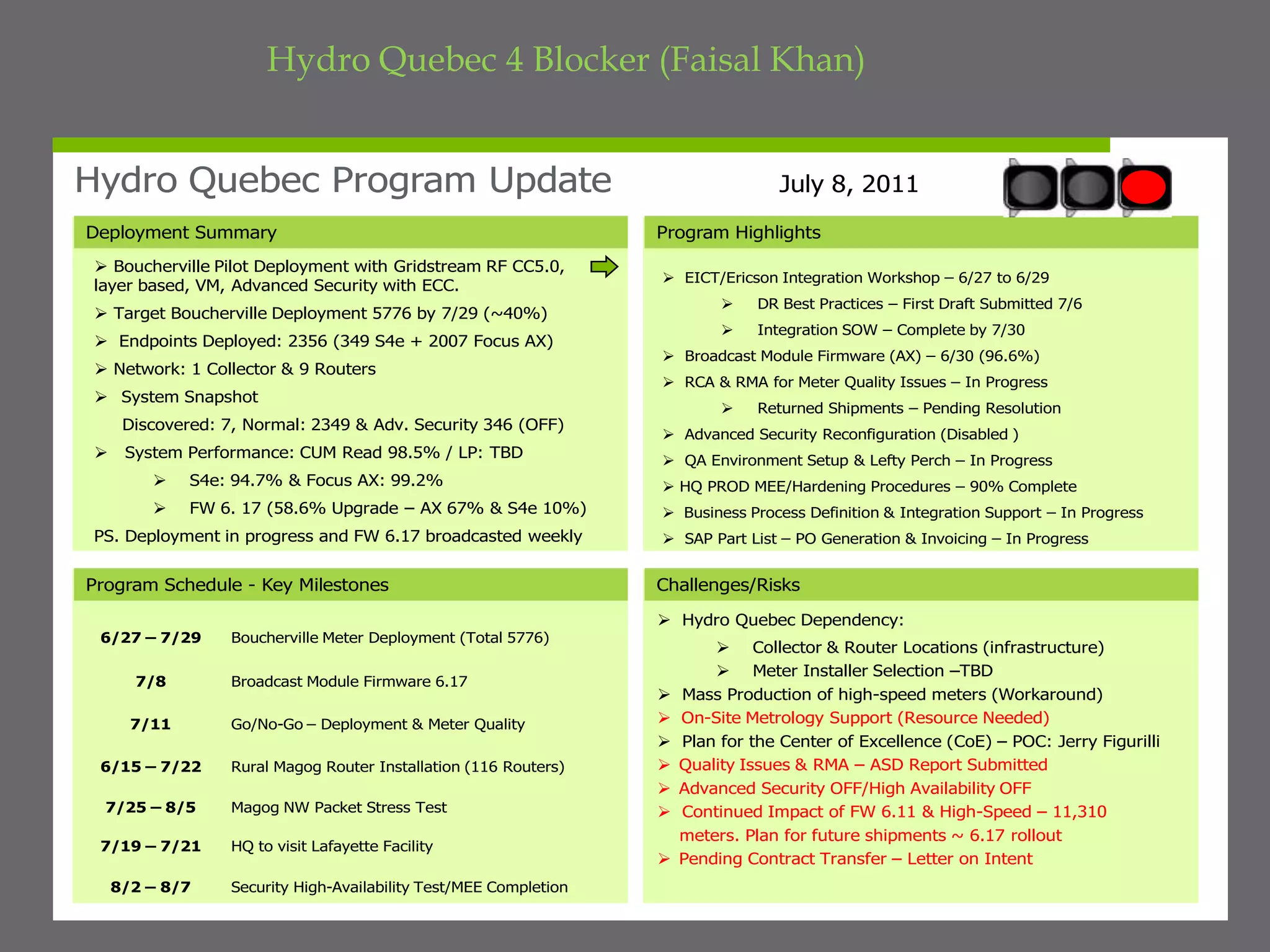

Hydro Quebec 4 Blocker (Faisal Khan)

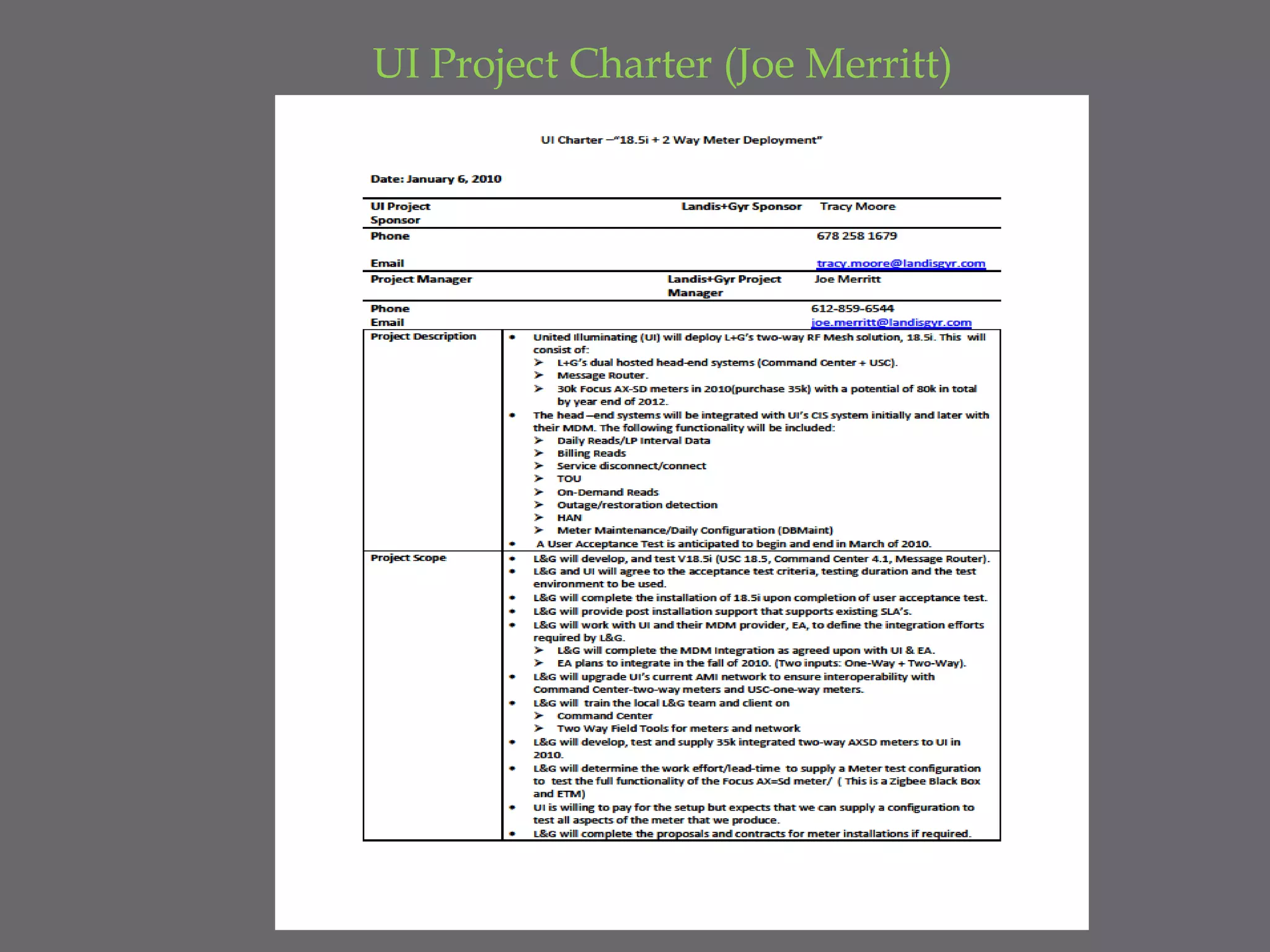

UI Project Charter (Joe Merritt)

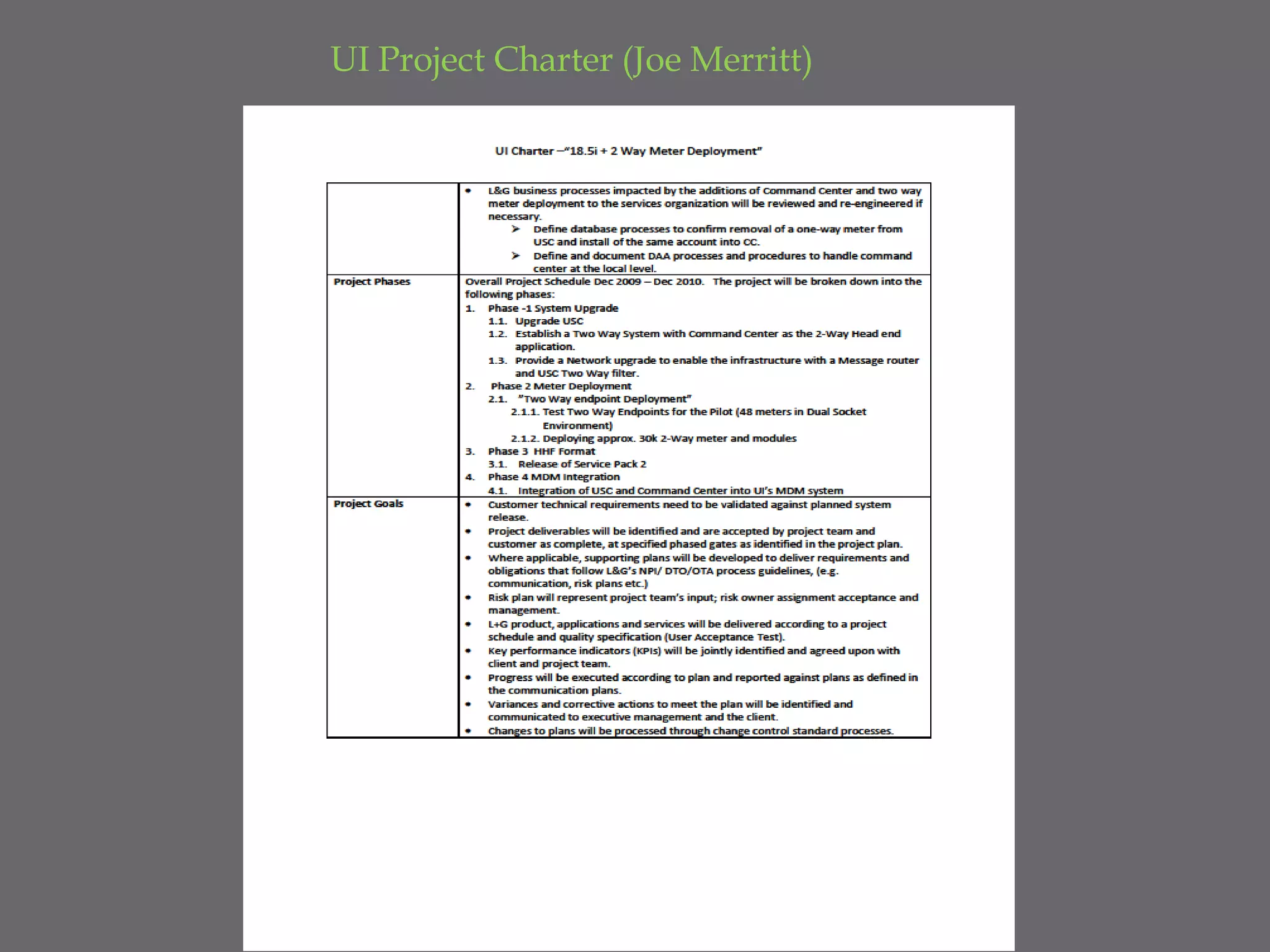

UI Project Charter (Joe Merritt)

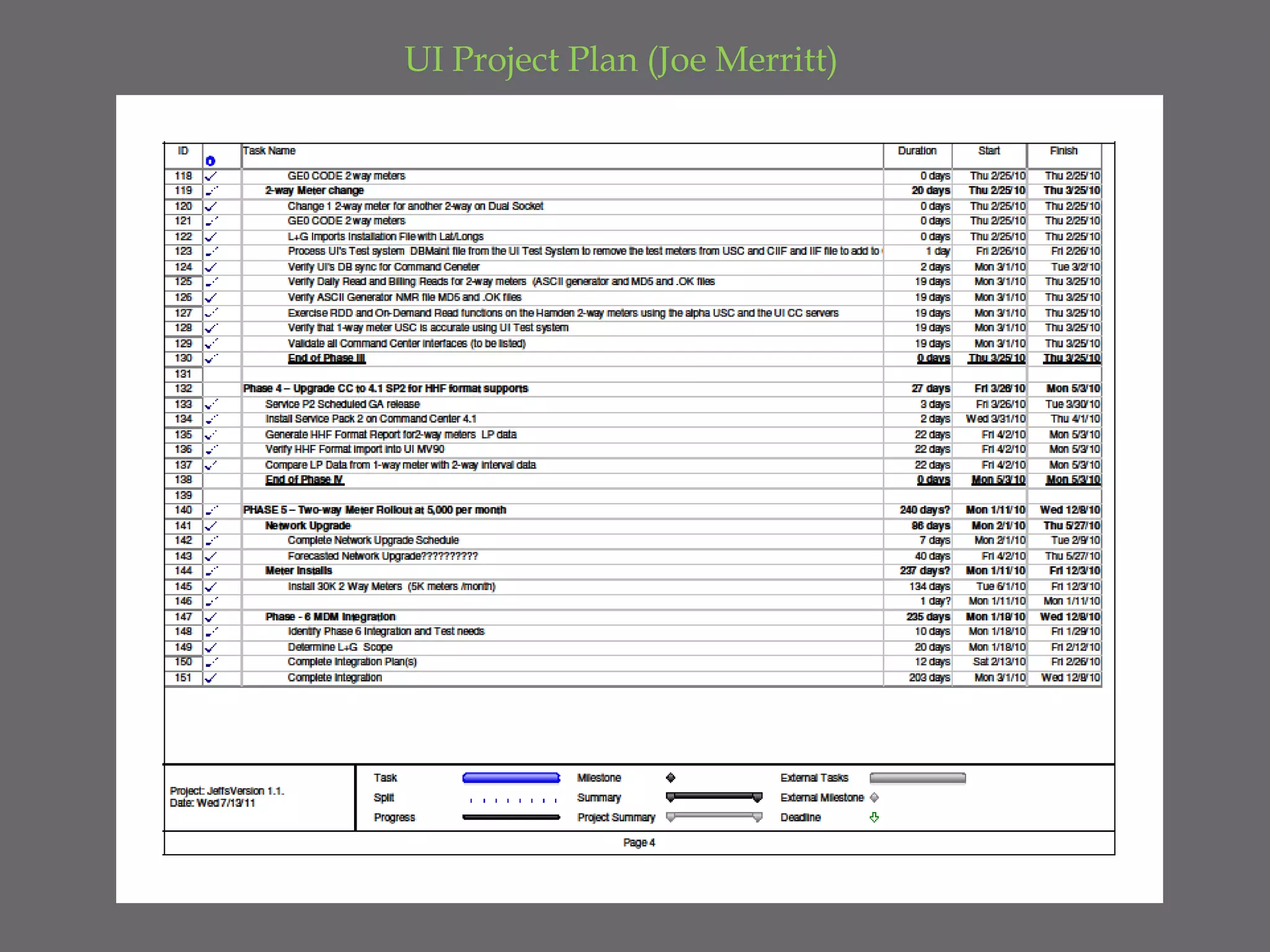

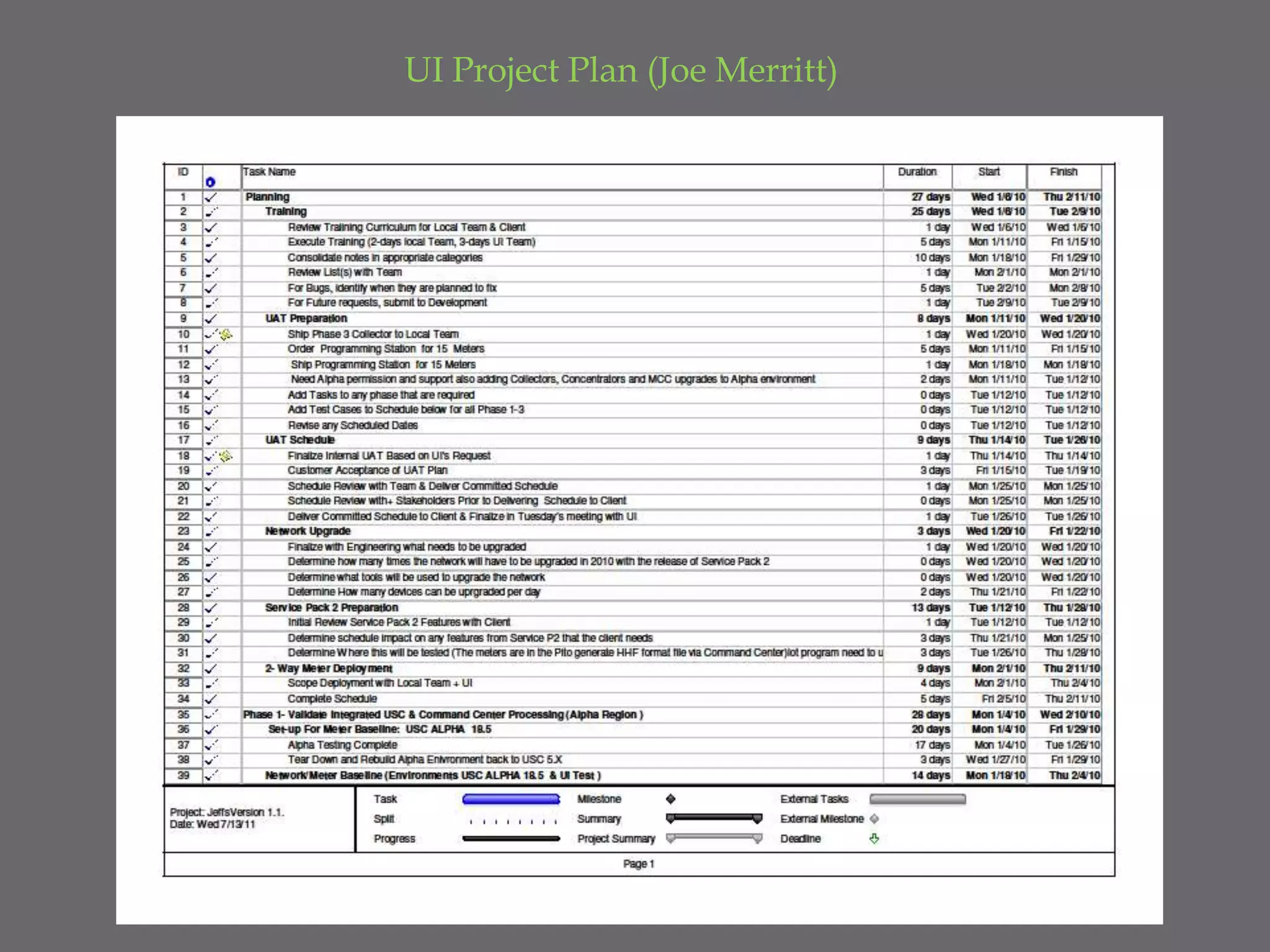

UI Project Plan (Joe Merritt)

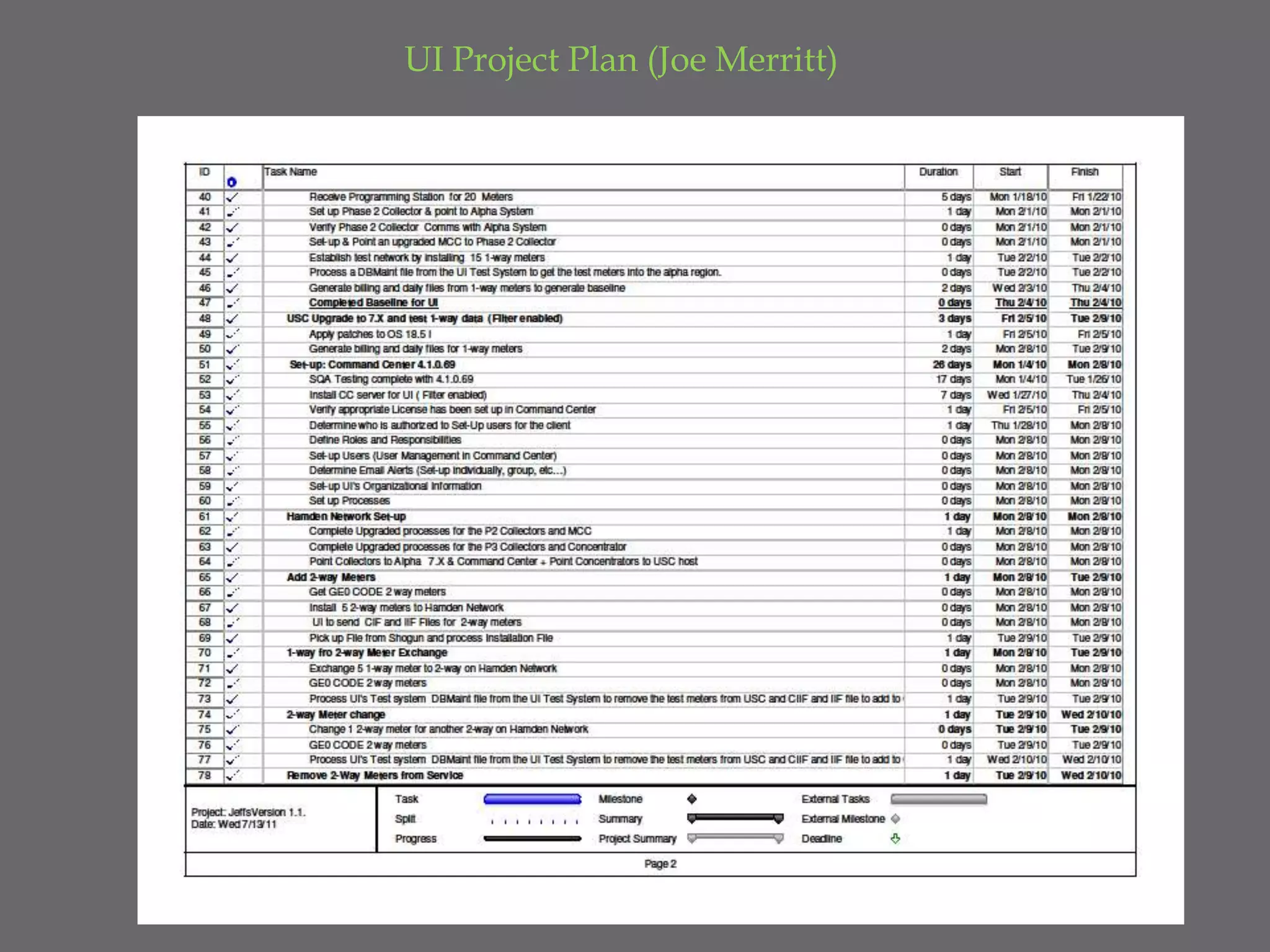

UI Project Plan (Joe Merritt)

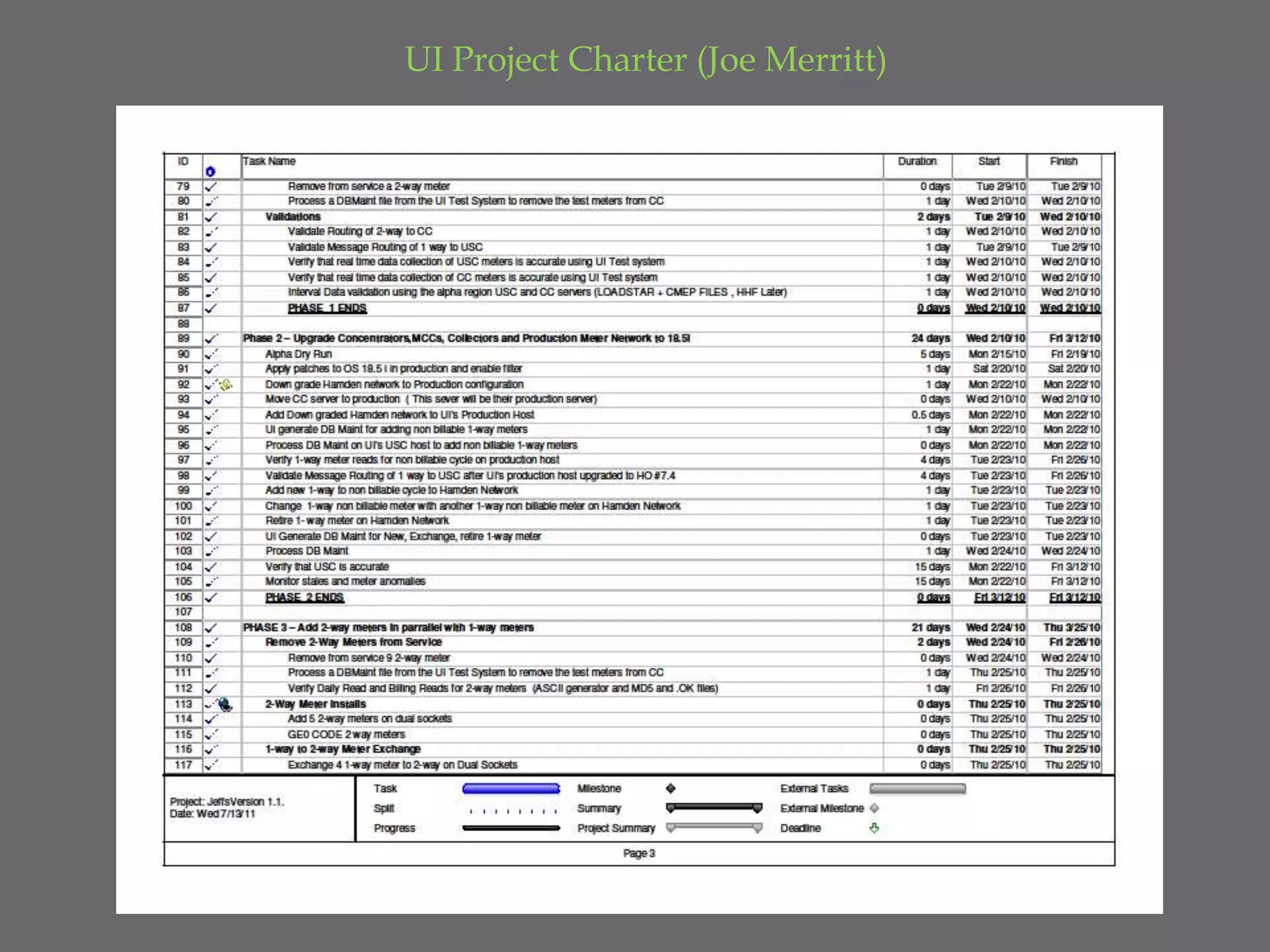

UI Project Charter (Joe Merritt)
UI Project Plan (Joe Merritt)

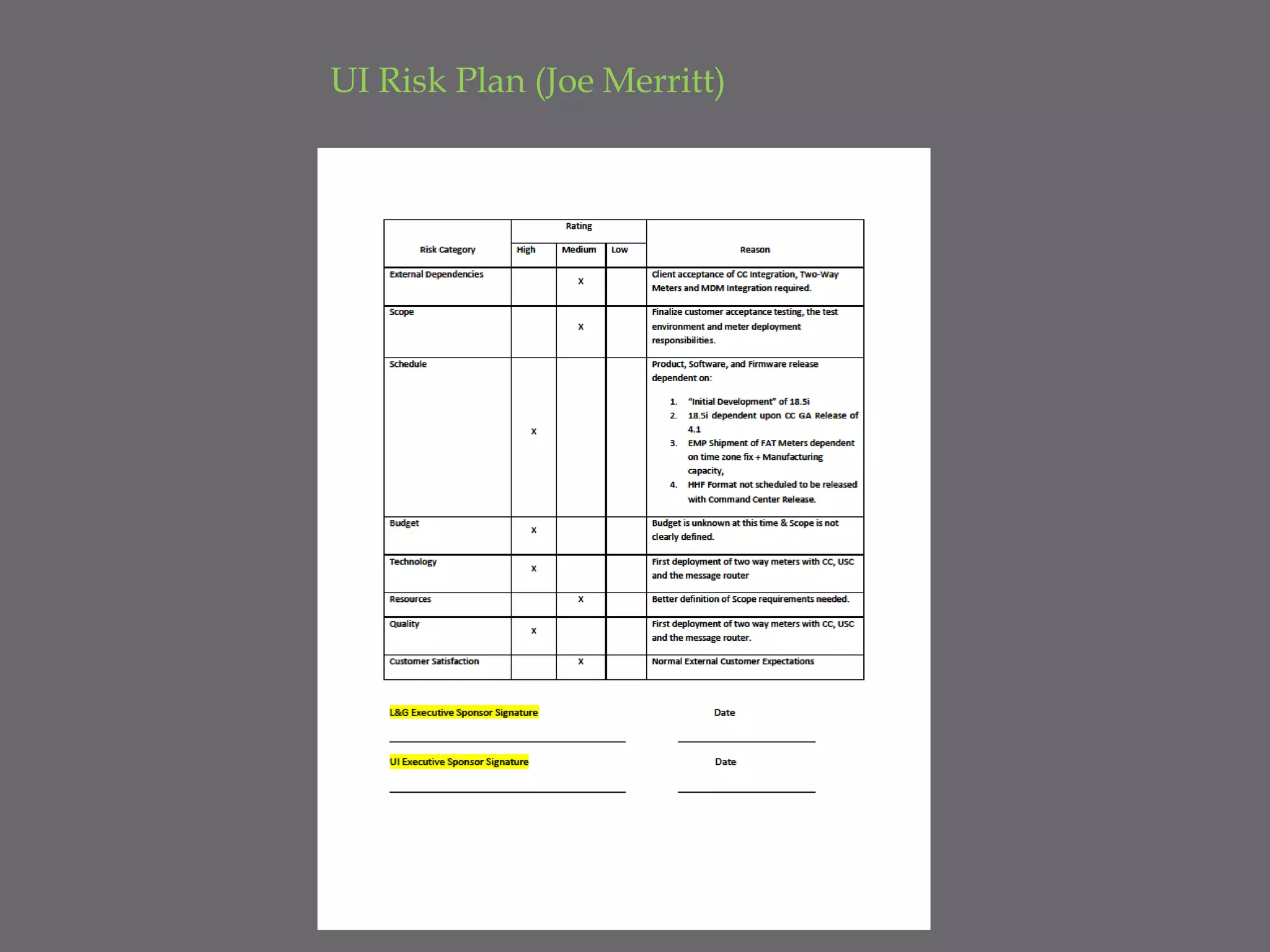

UI Risk Plan (Joe Merritt)

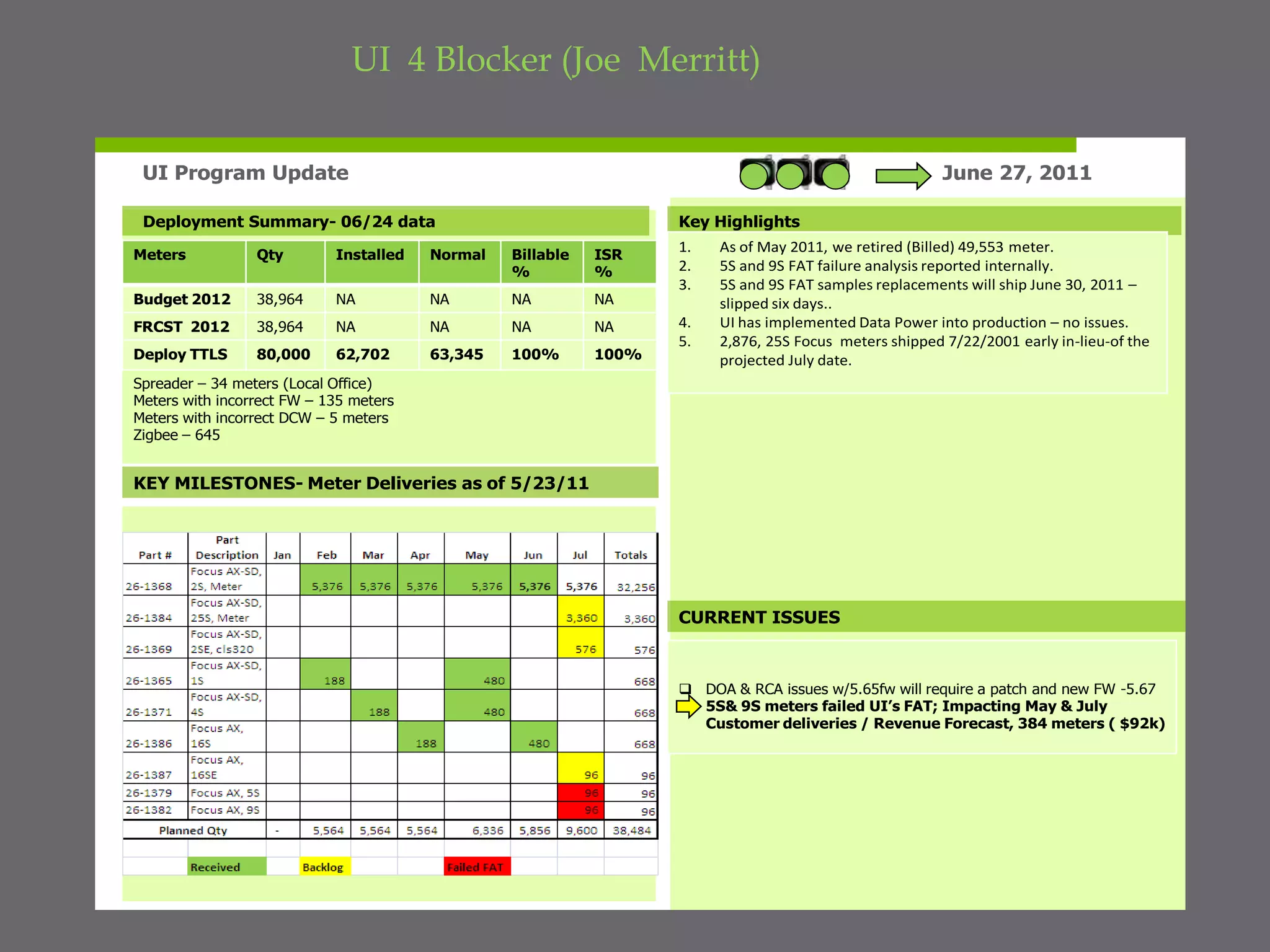

UI  4 Blocker (Joe  Merritt)

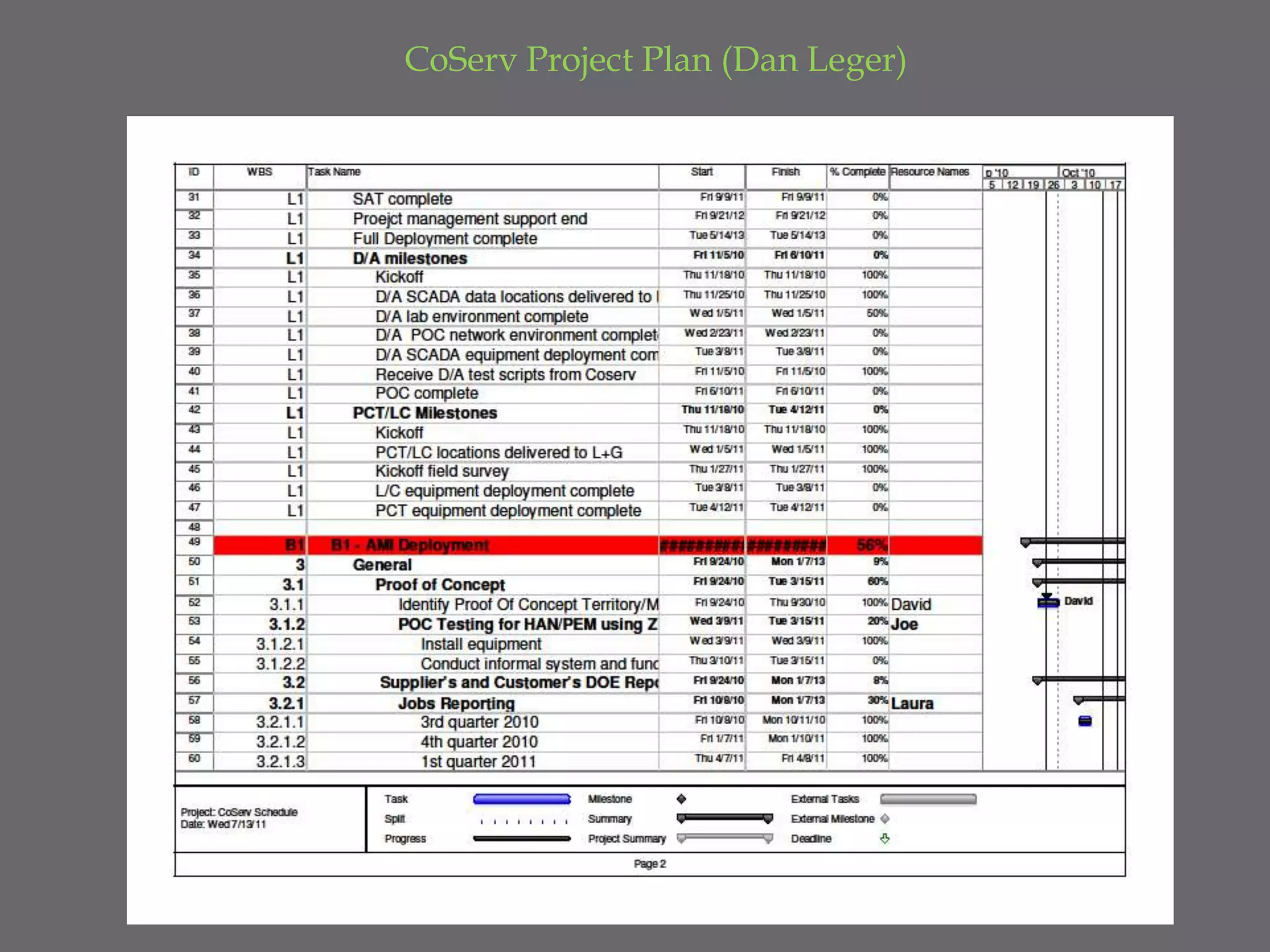

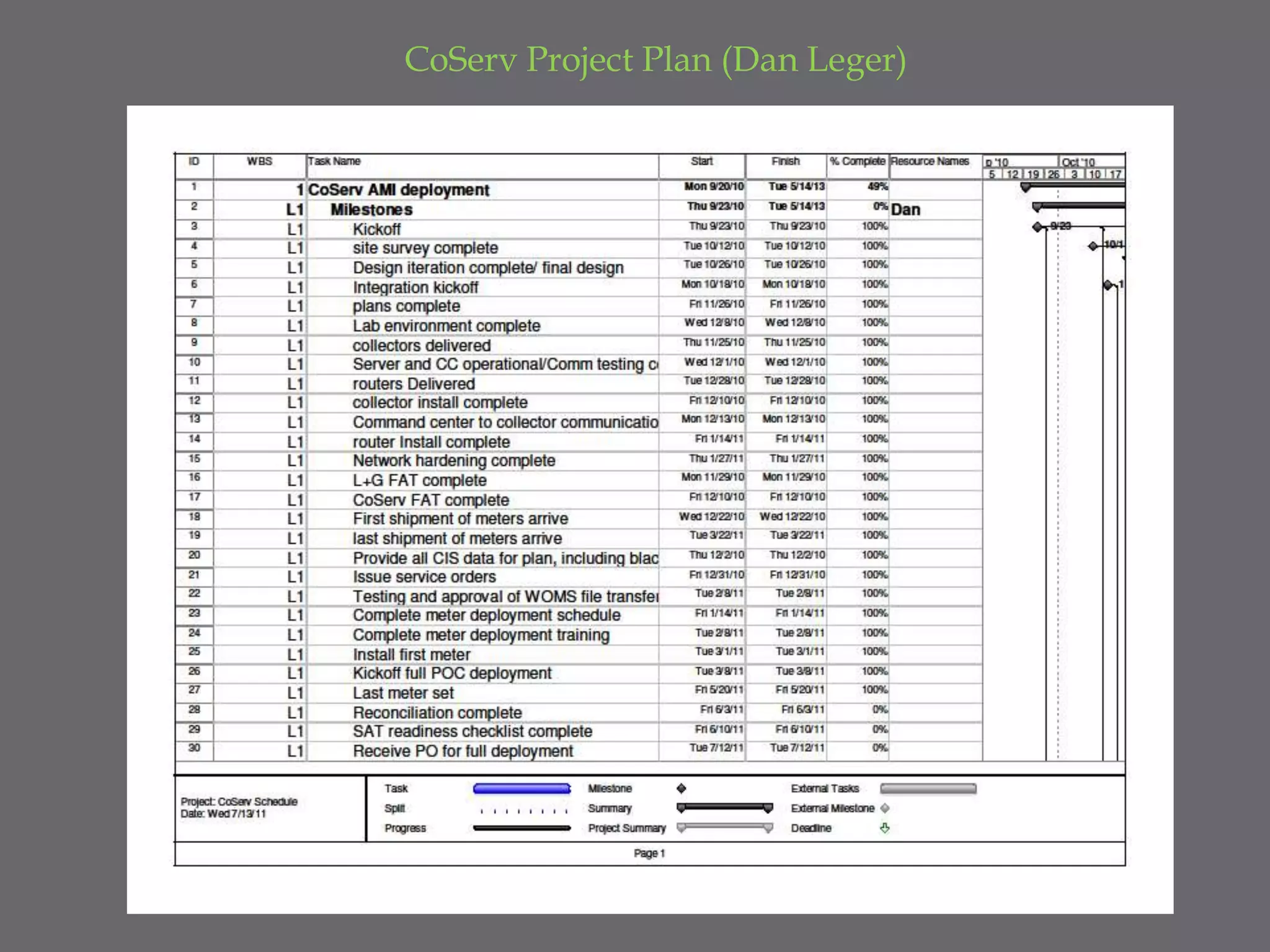

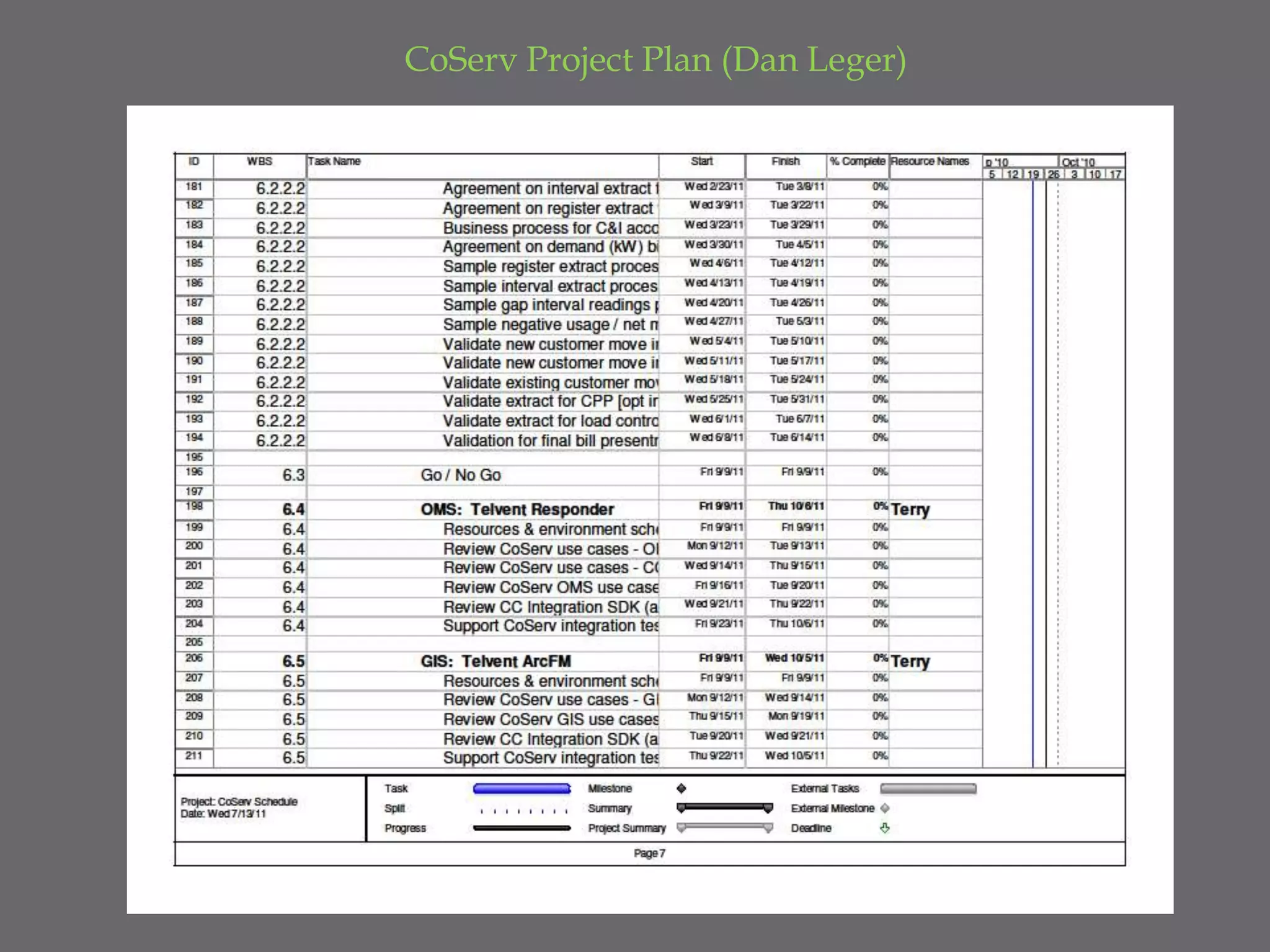

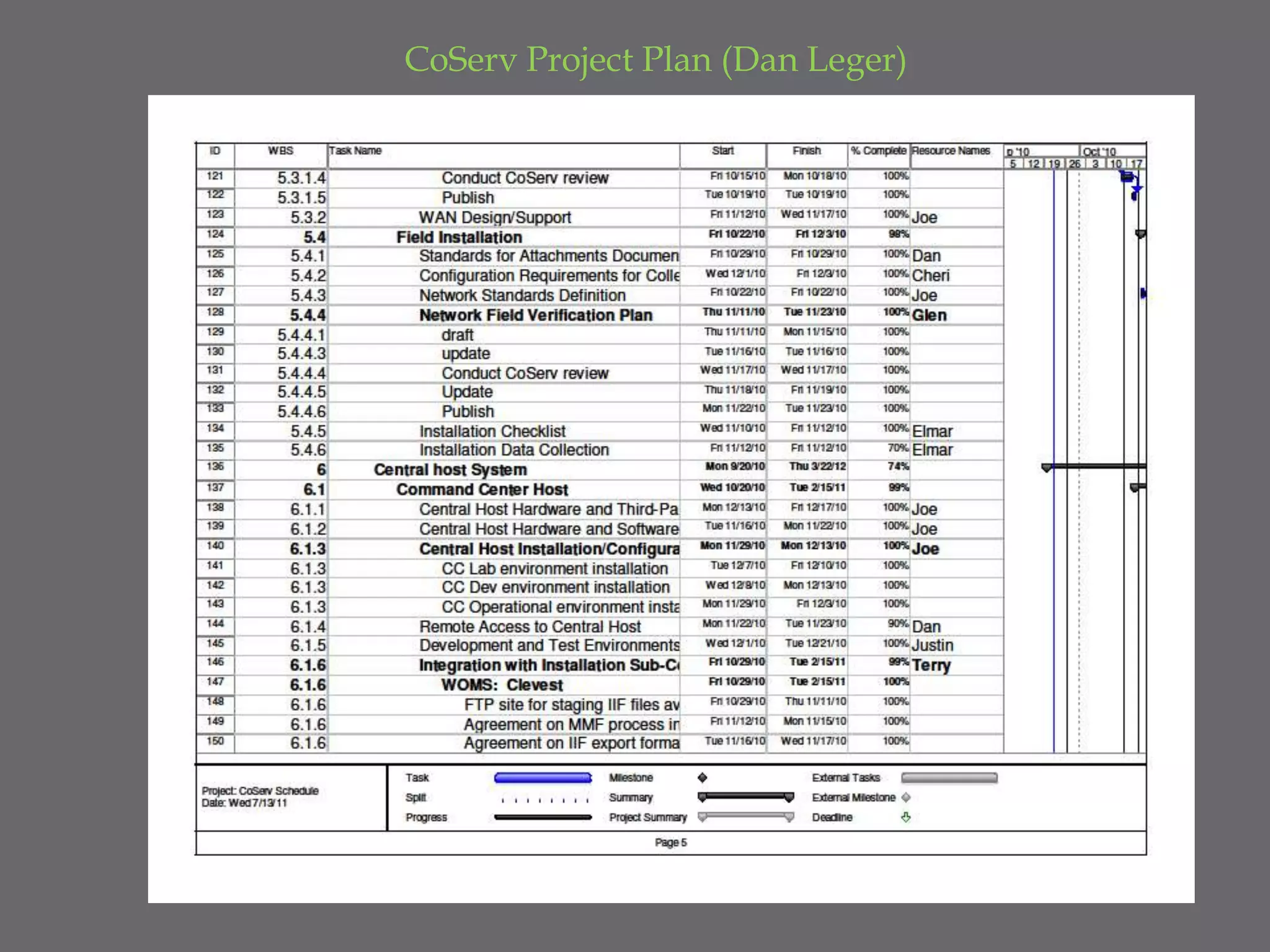

CoServ Project Plan (Dan Leger)
CoServ Project Plan (Dan Leger)

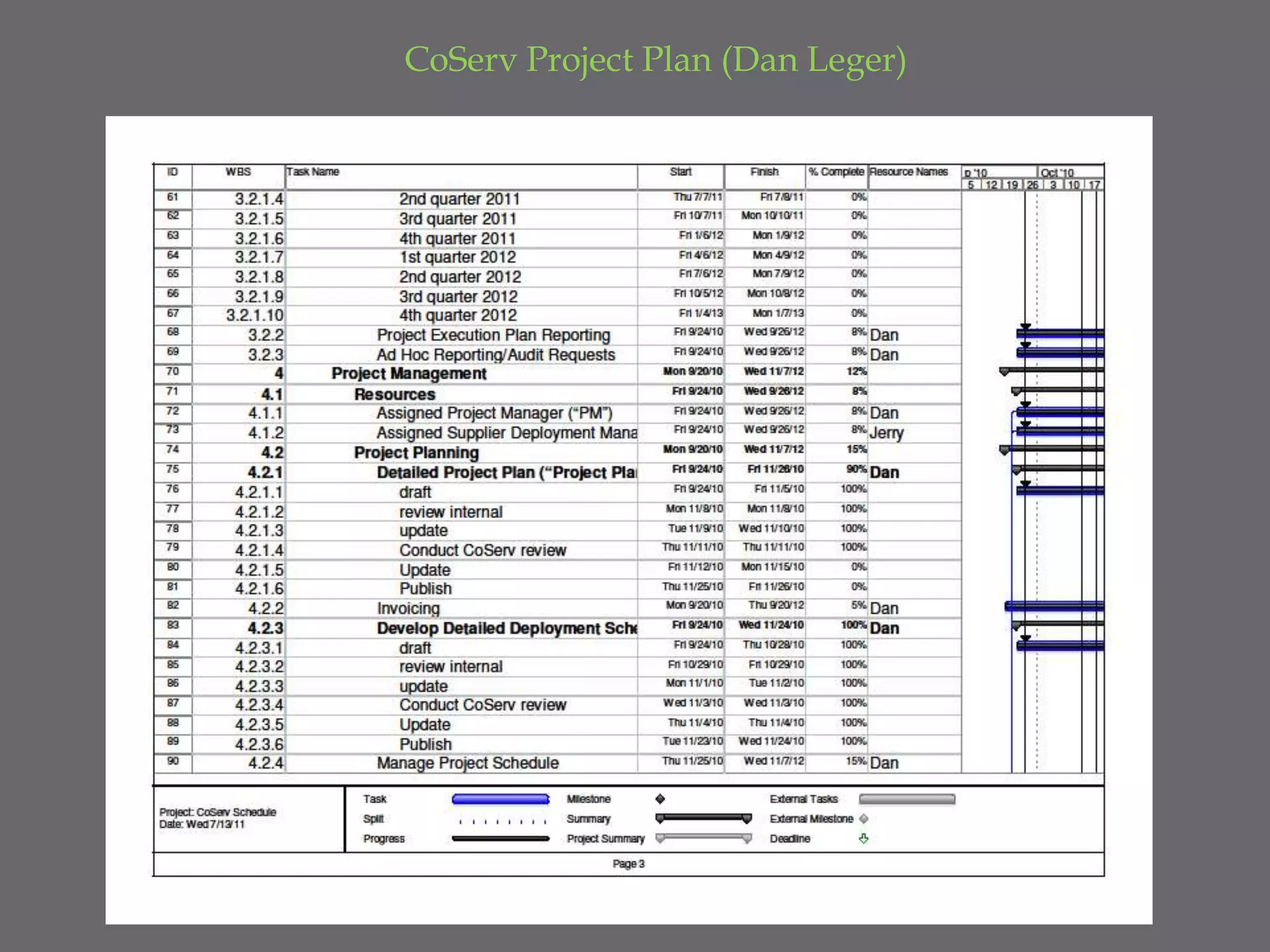

CoServ Project Plan (Dan Leger)

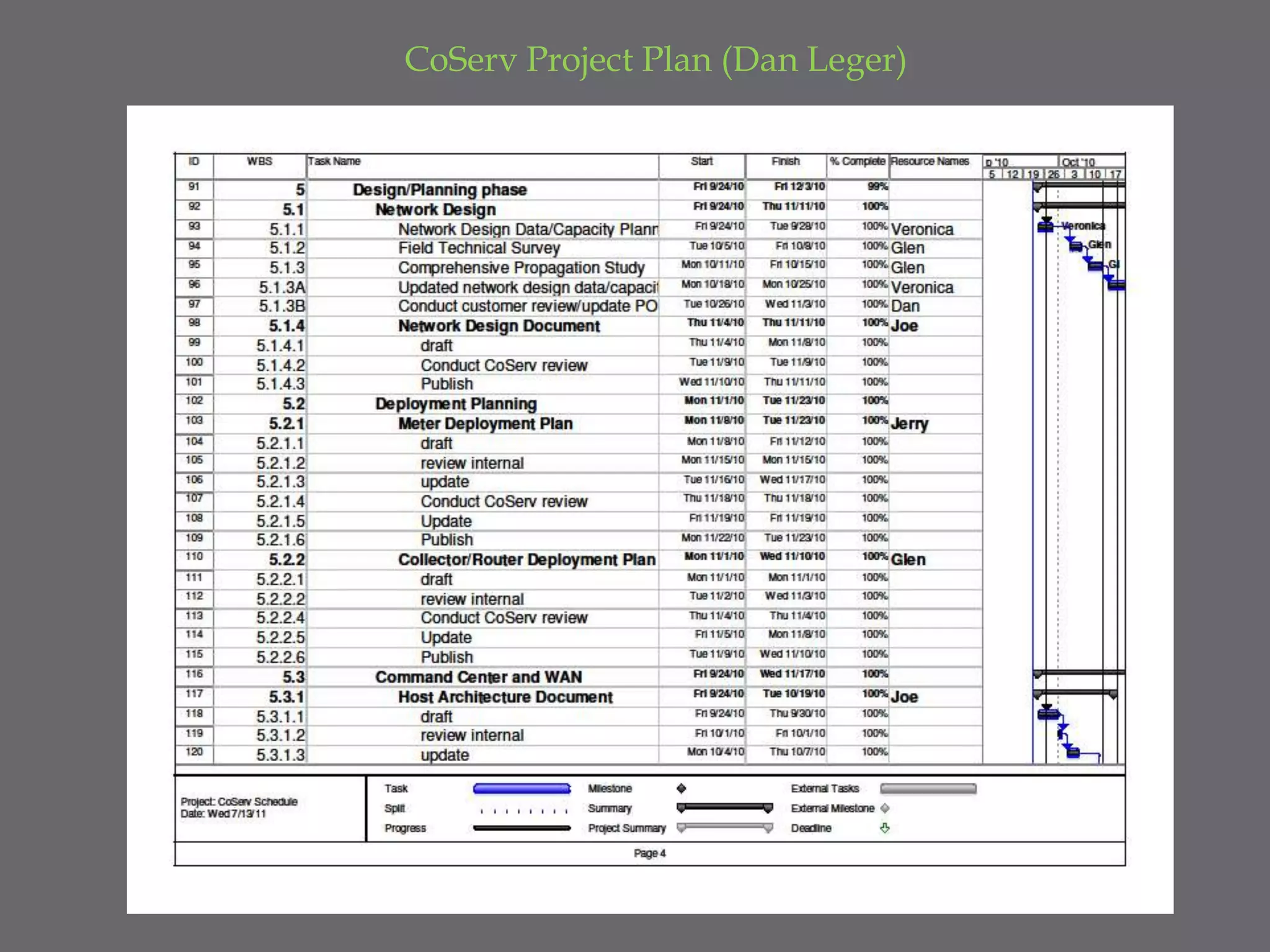

CoServ Project Plan (Dan Leger)

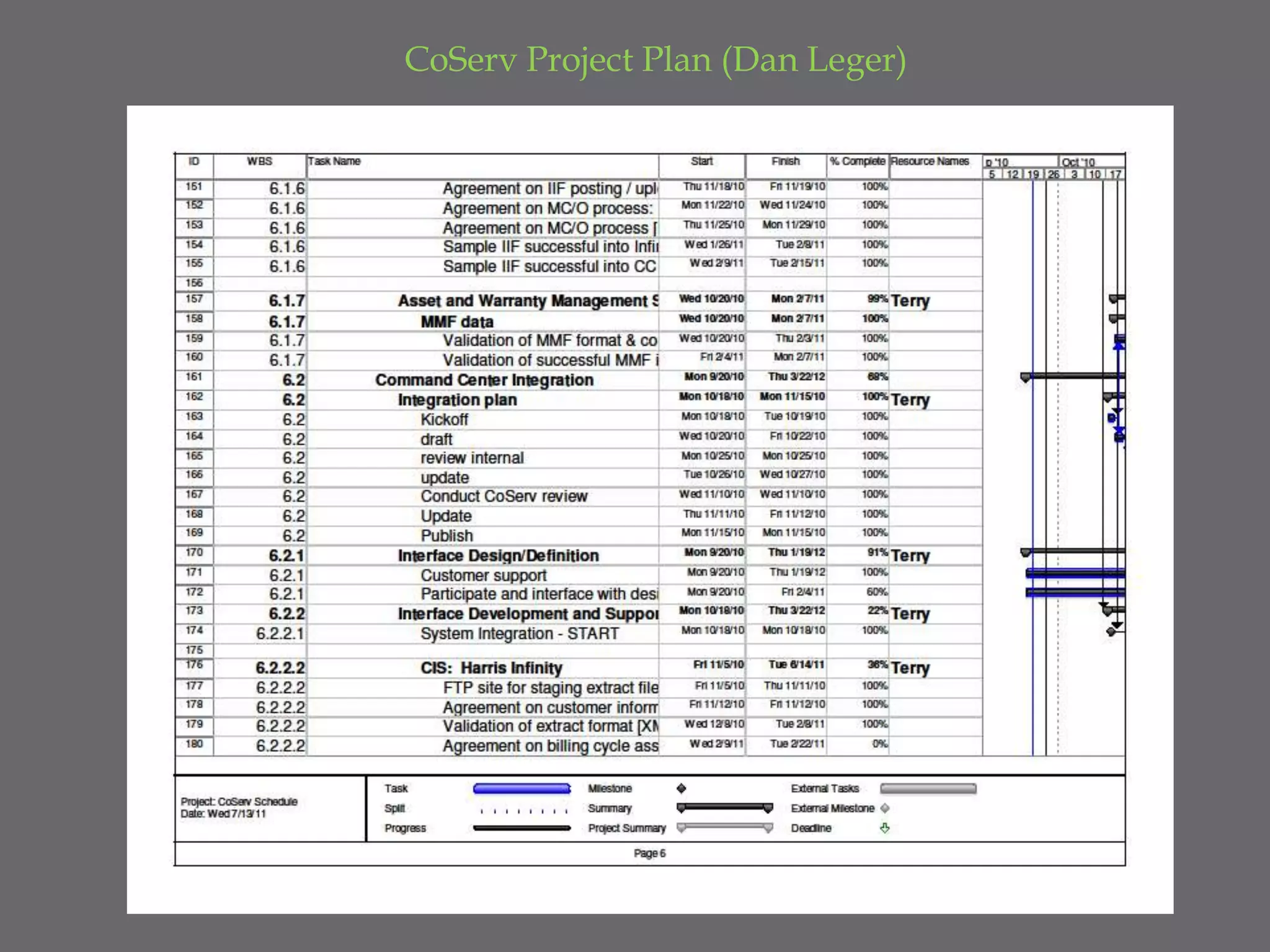

CoServ Project Plan (Dan Leger)
CoServ Project Plan (Dan Leger)
CoServ Project Plan (Dan Leger)

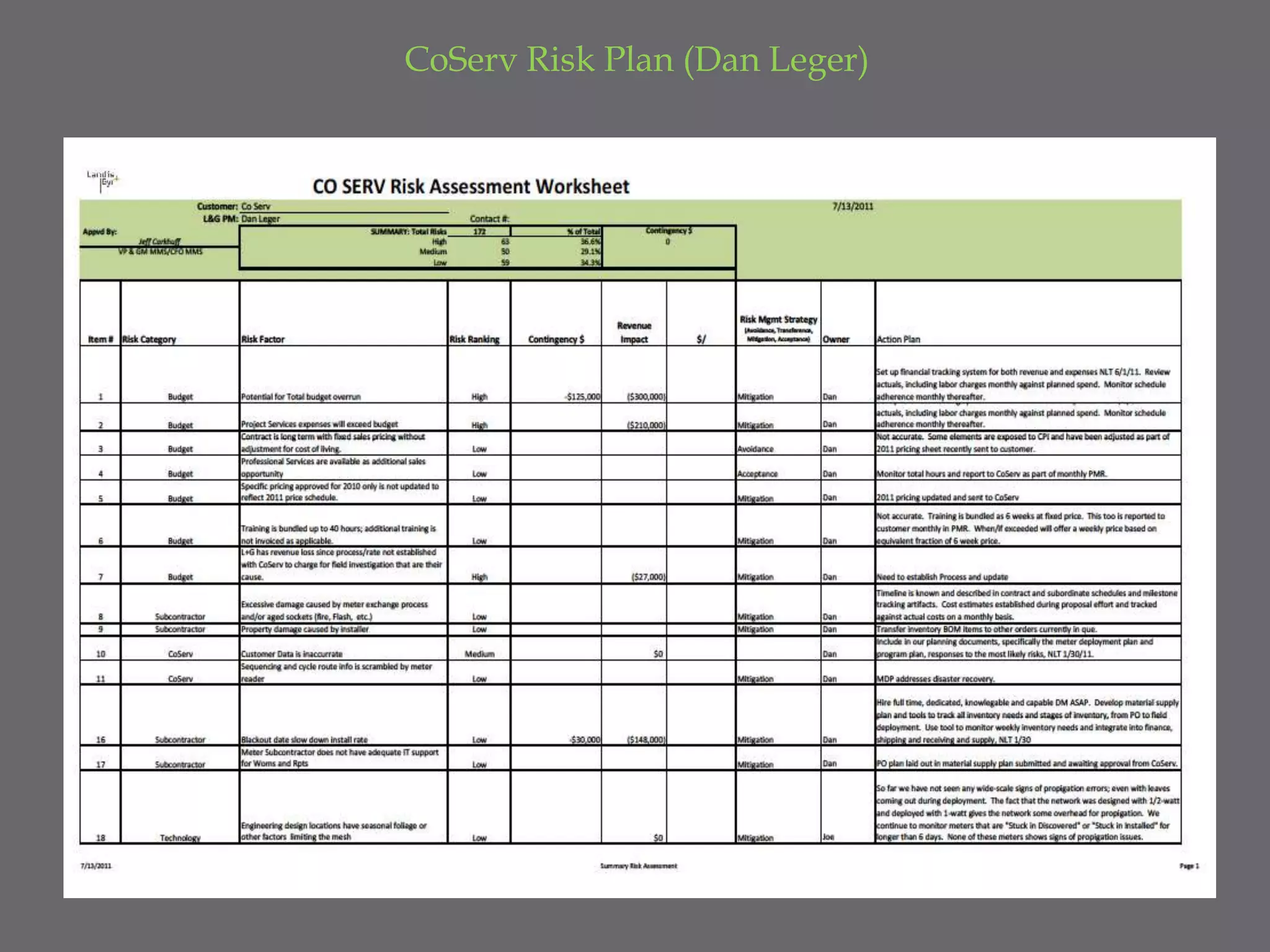

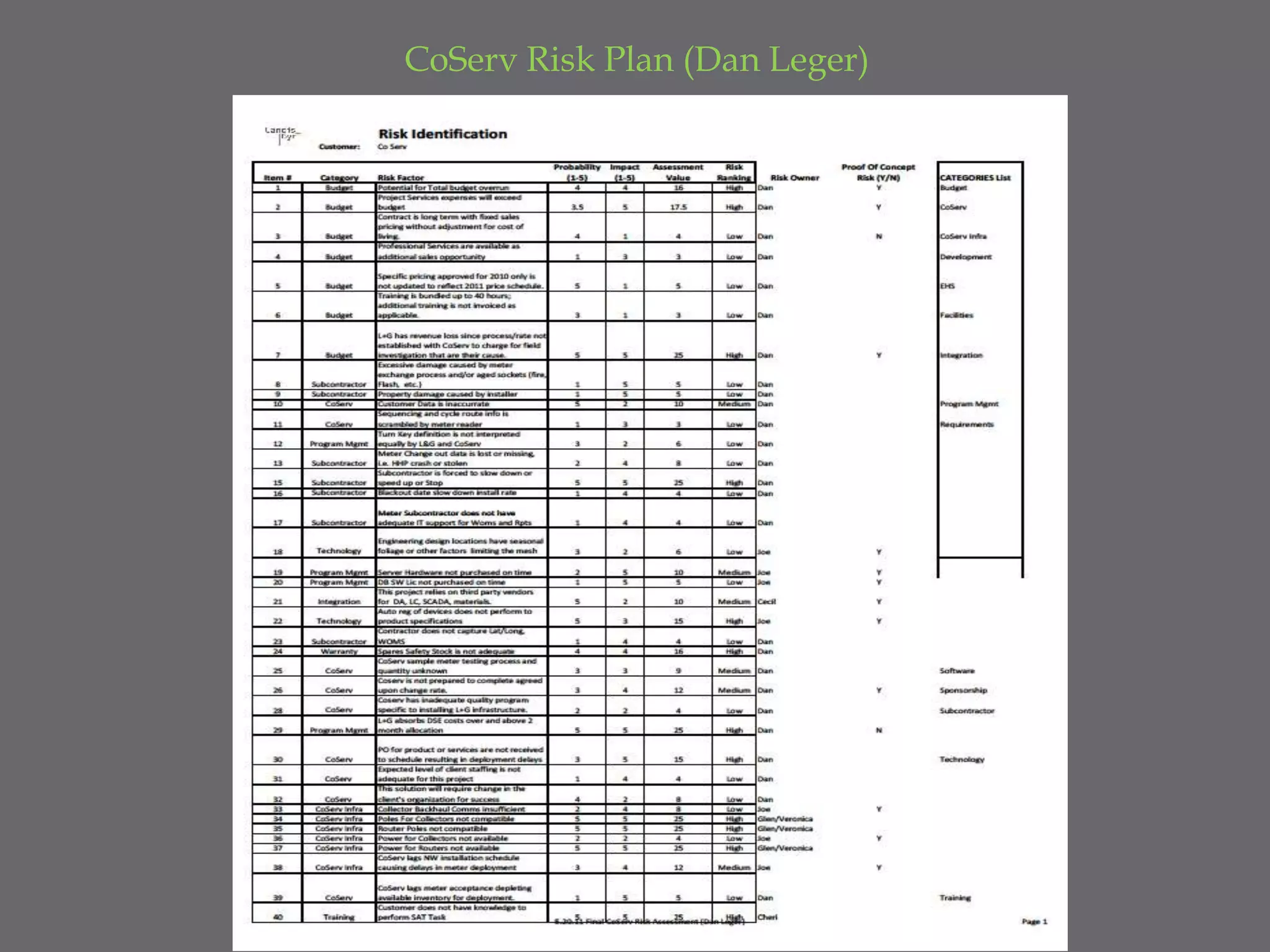

CoServ Risk Plan (Dan Leger)
CoServ Risk Plan (Dan Leger)

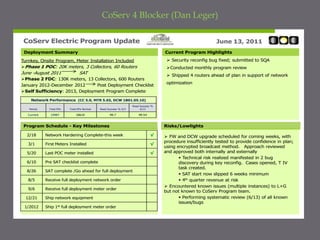

CoServ 4 Blocker (Dan Leger)

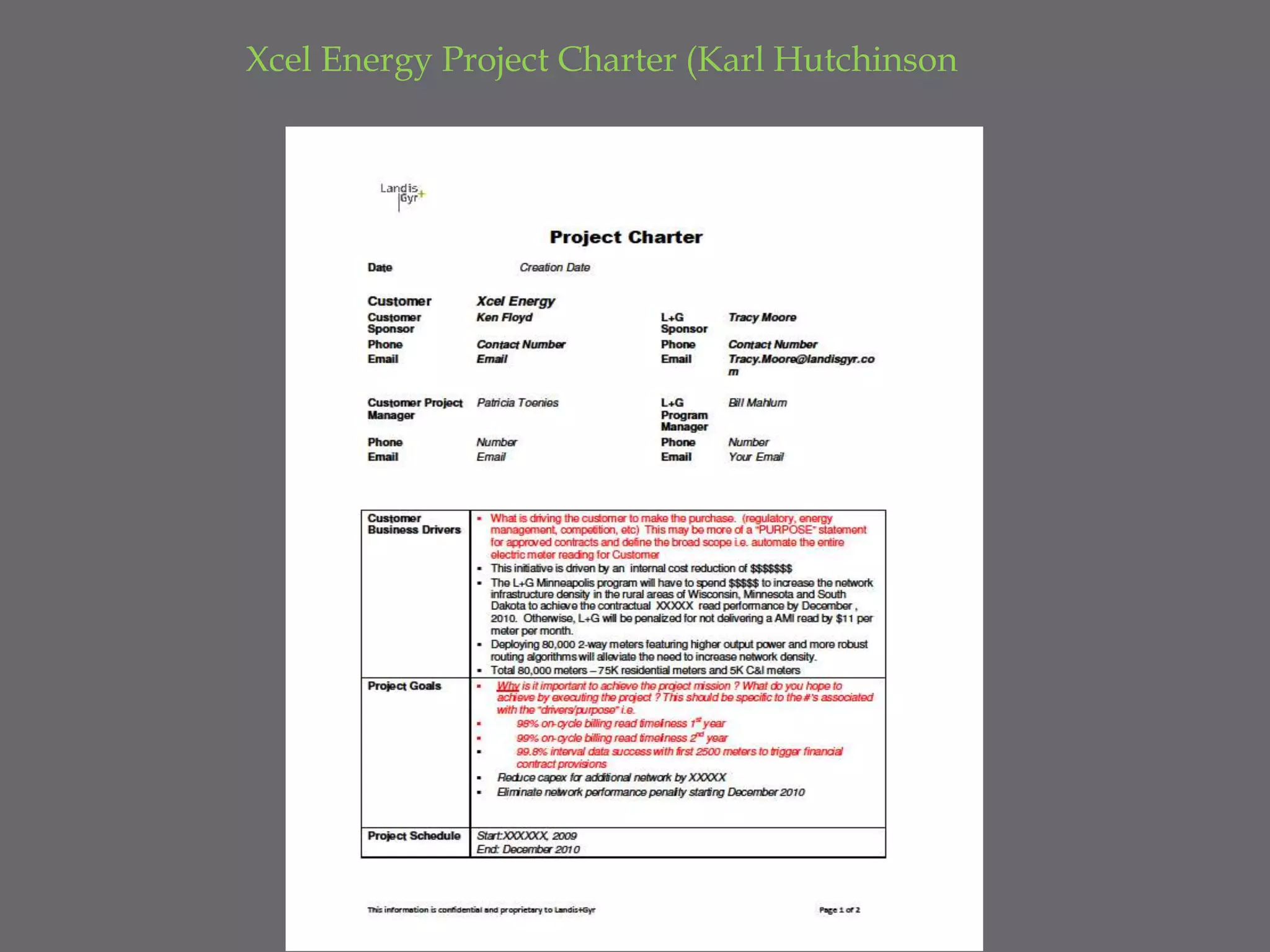

Xcel Energy Project Charter (Karl Hutchinson

Xcel Project Charter (Karl Hutchinson)

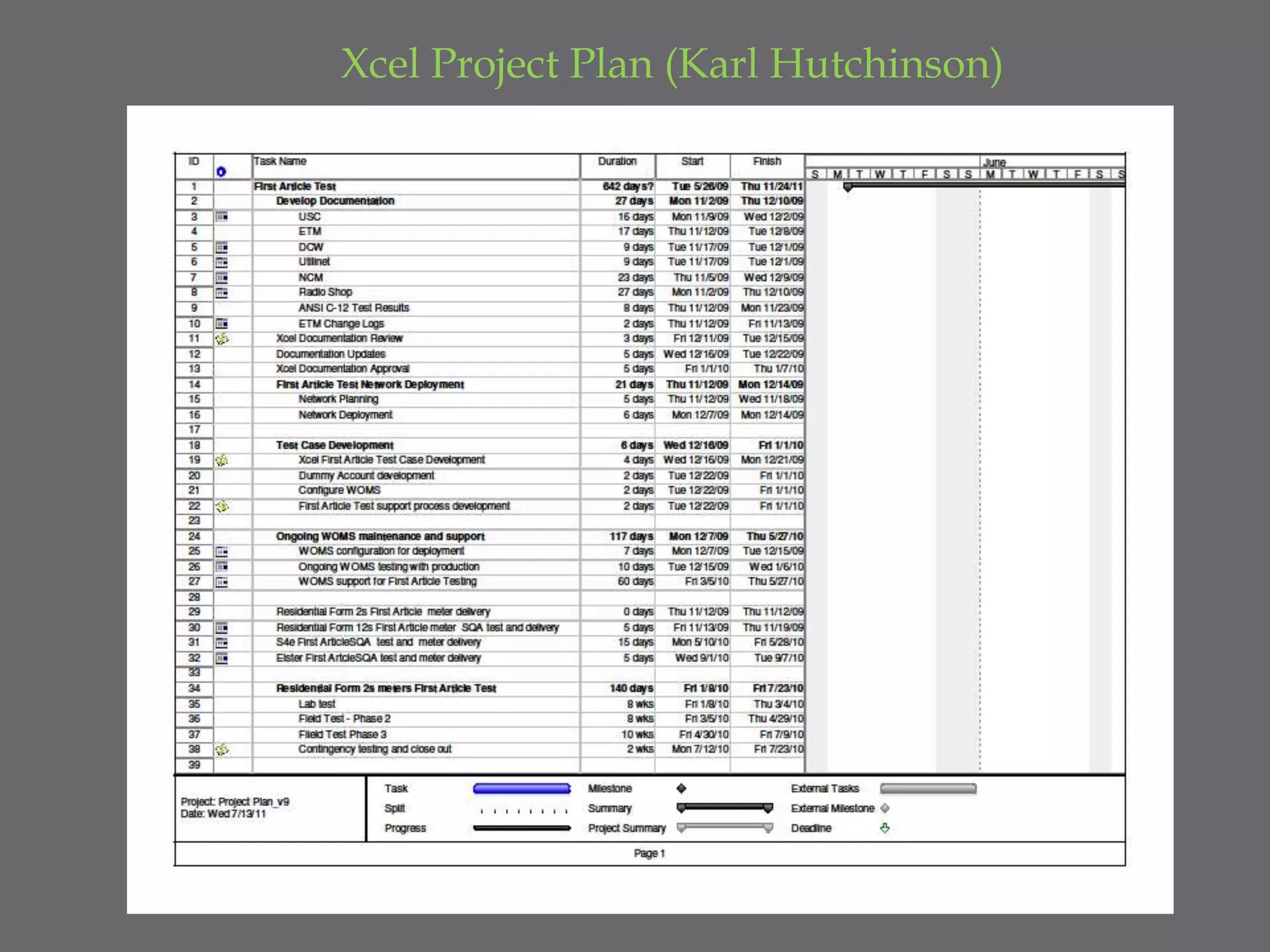

Xcel Project Plan (Karl Hutchinson)

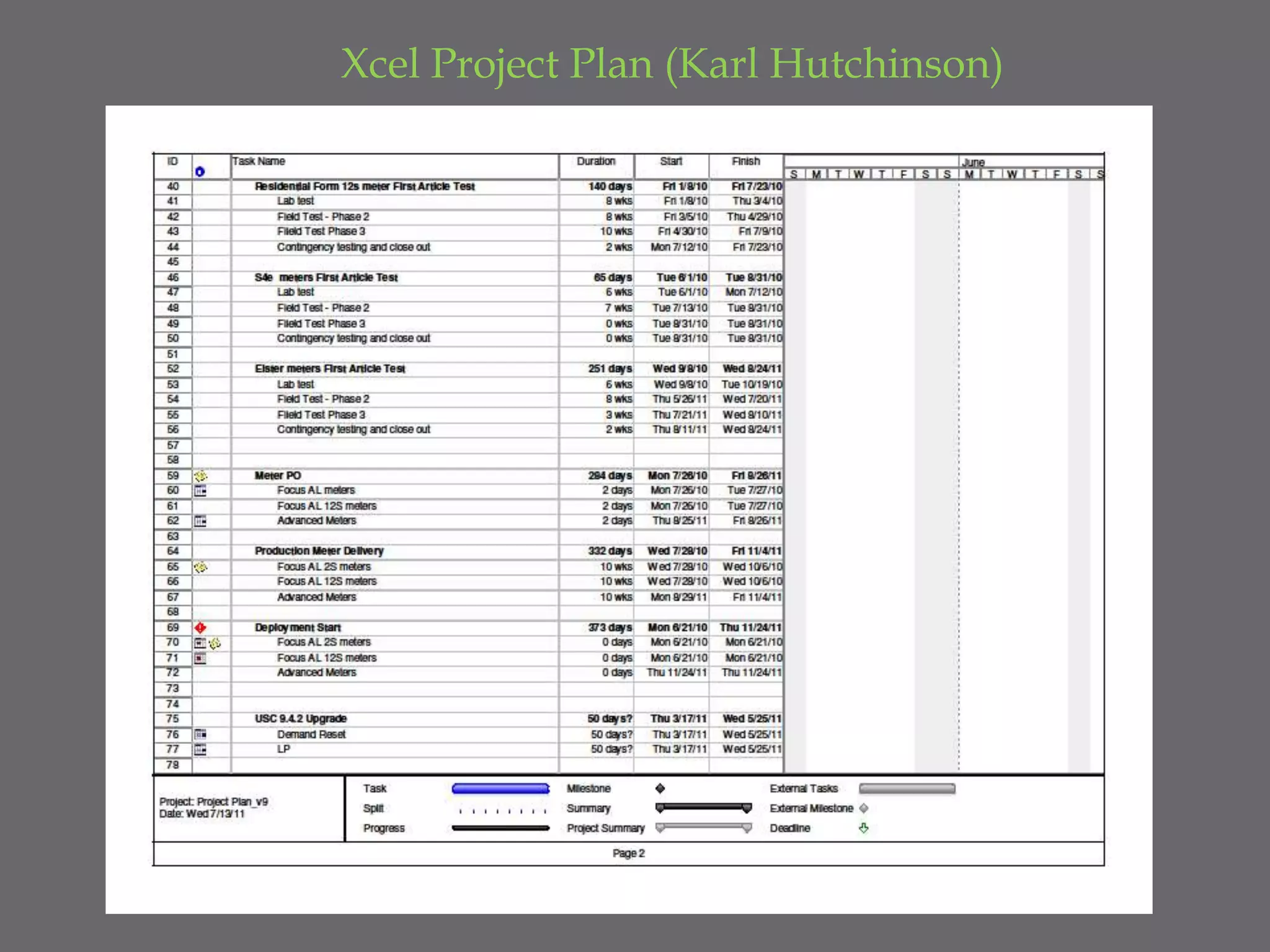

Xcel Project Plan (Karl Hutchinson)

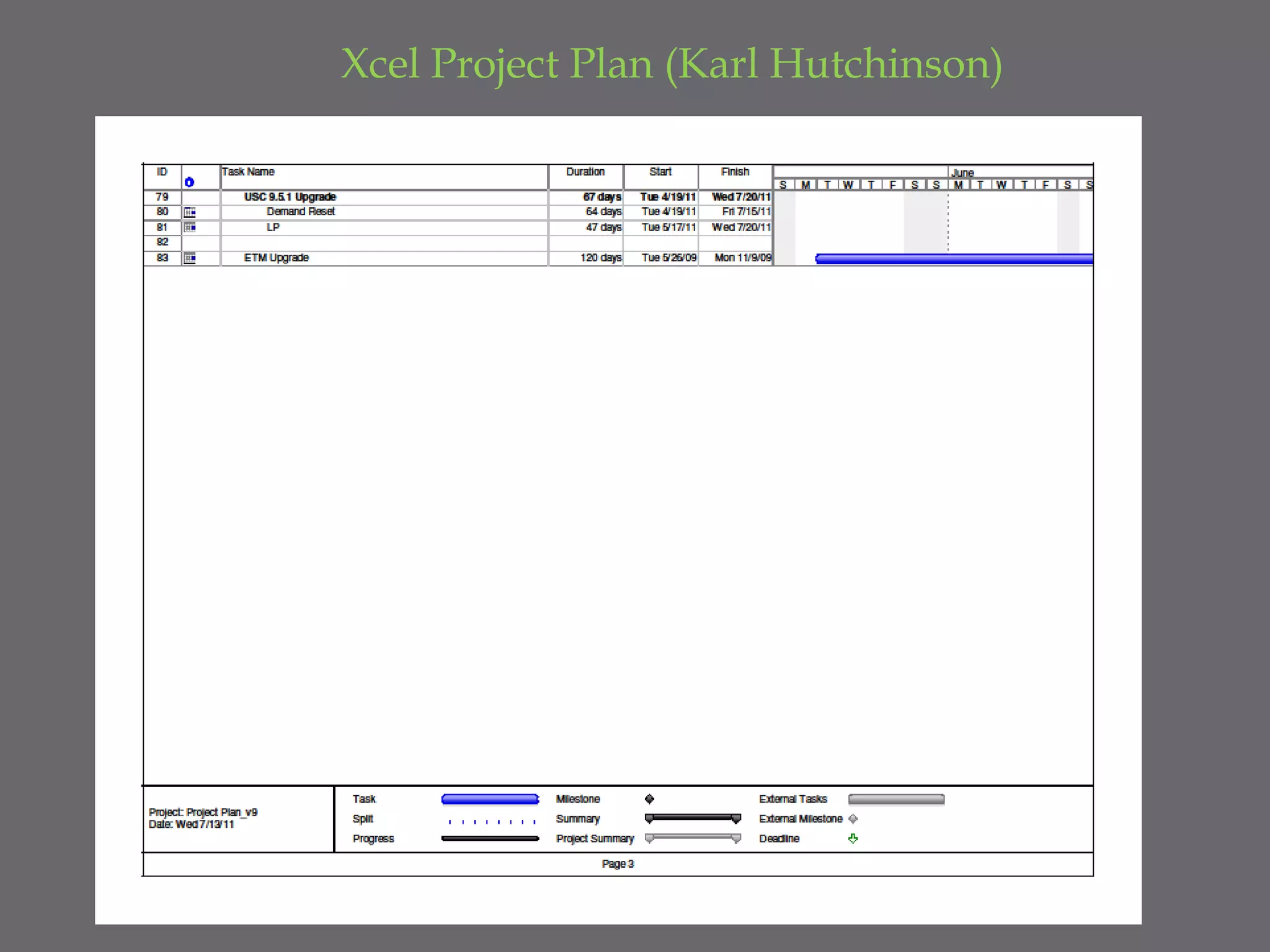

Xcel Project Plan (Karl Hutchinson)

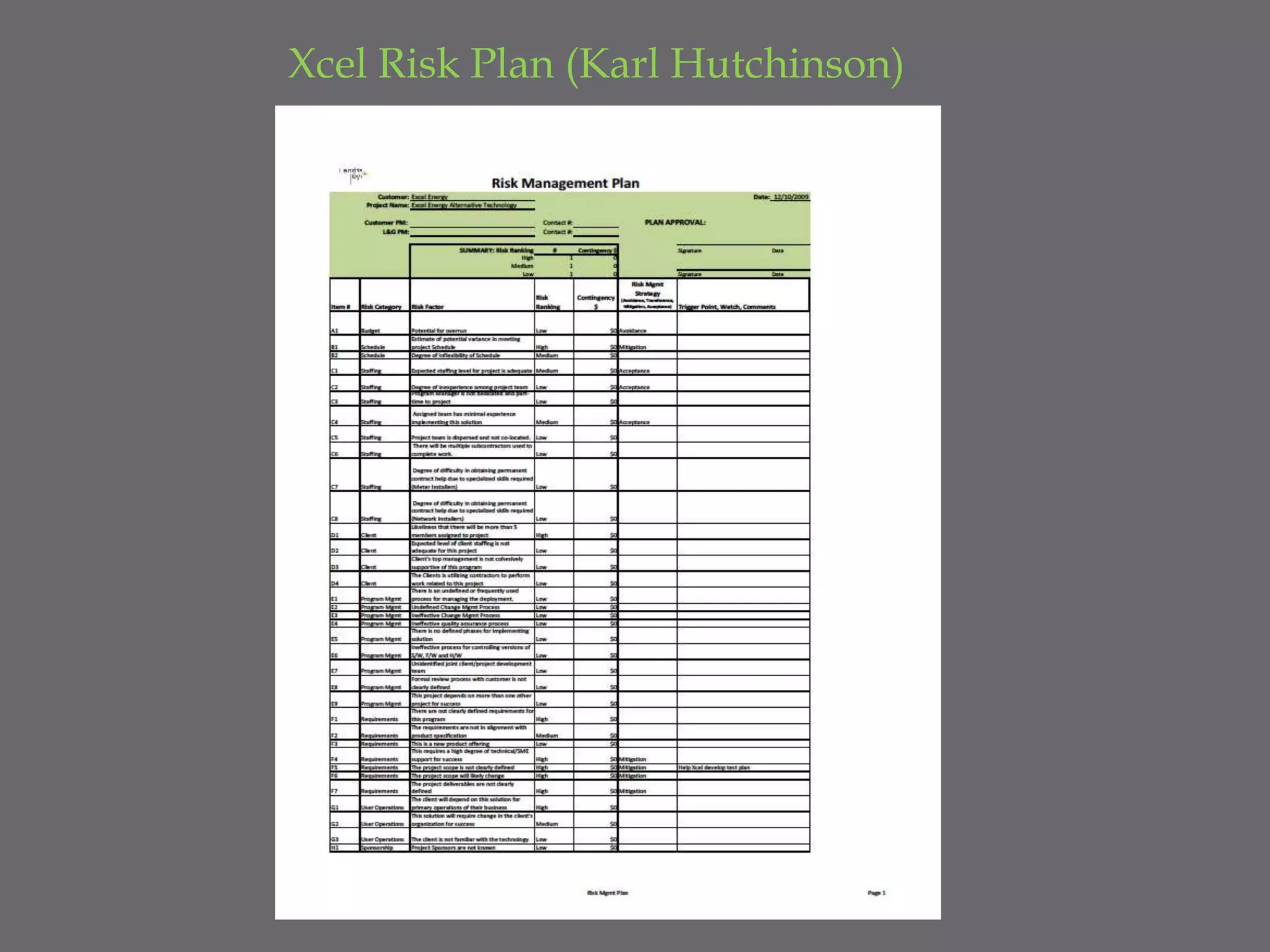

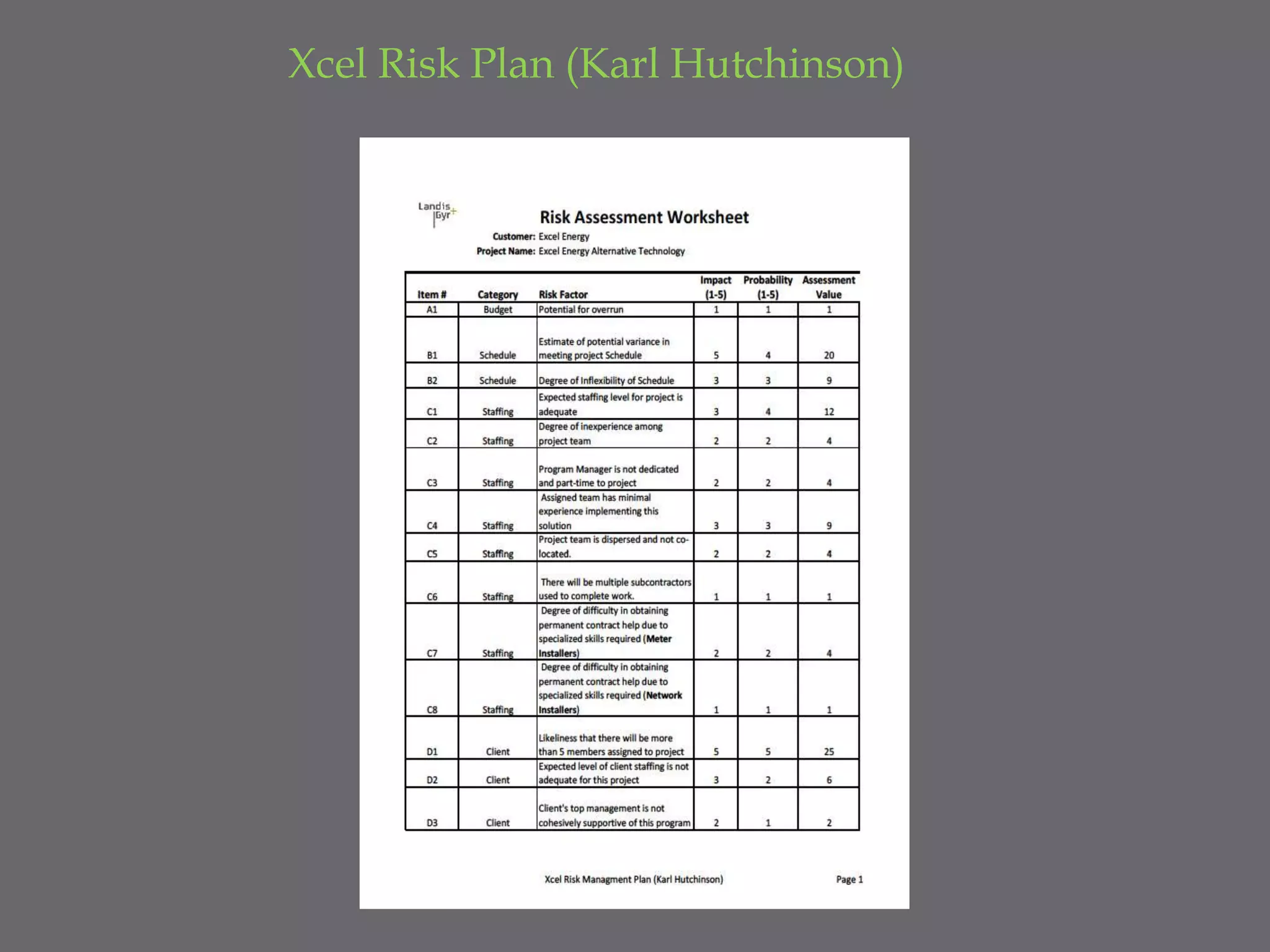

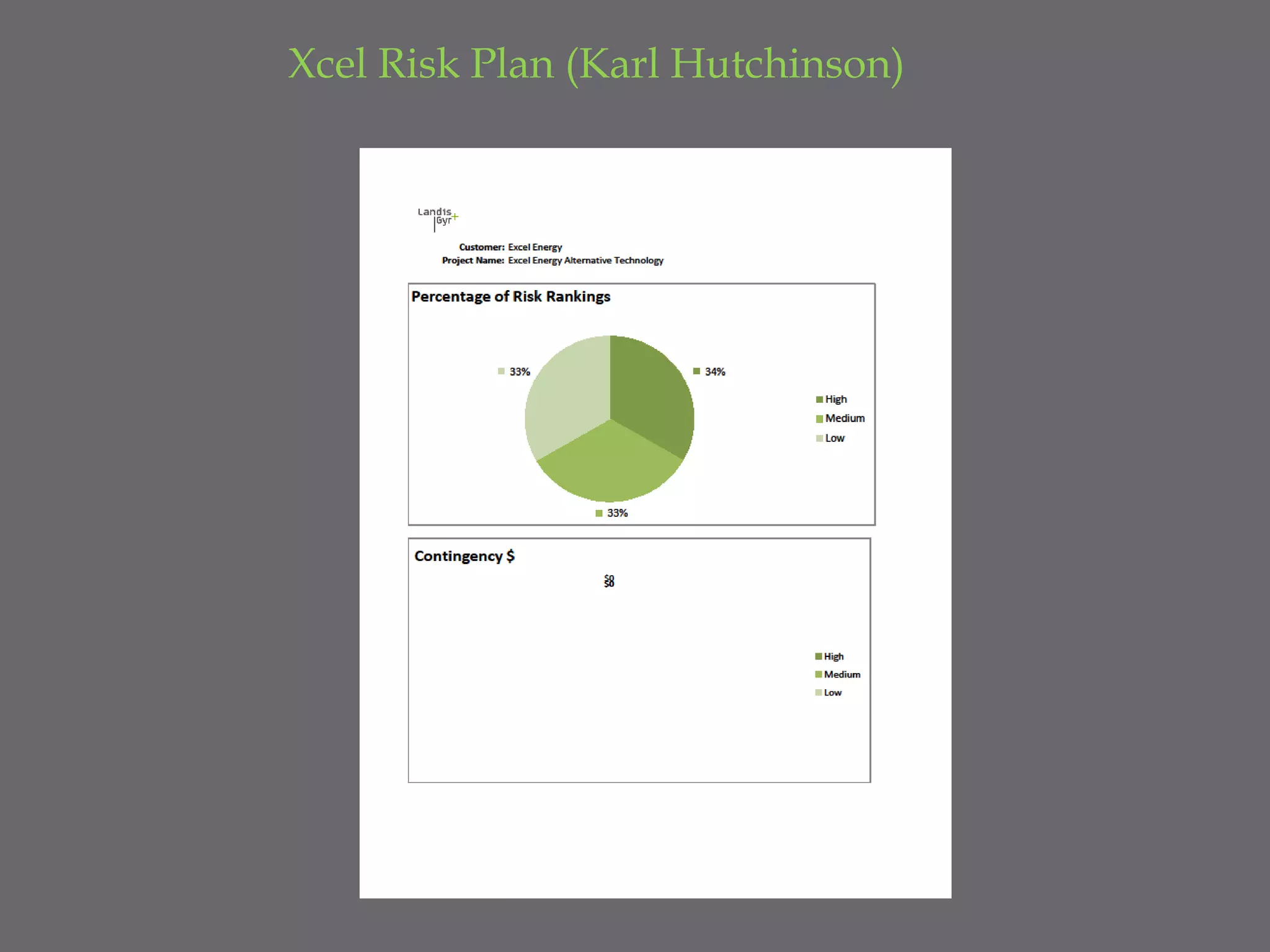

Xcel Risk Plan (Karl Hutchinson)
Xcel Risk Plan (Karl Hutchinson)
Xcel Risk Plan (Karl Hutchinson)

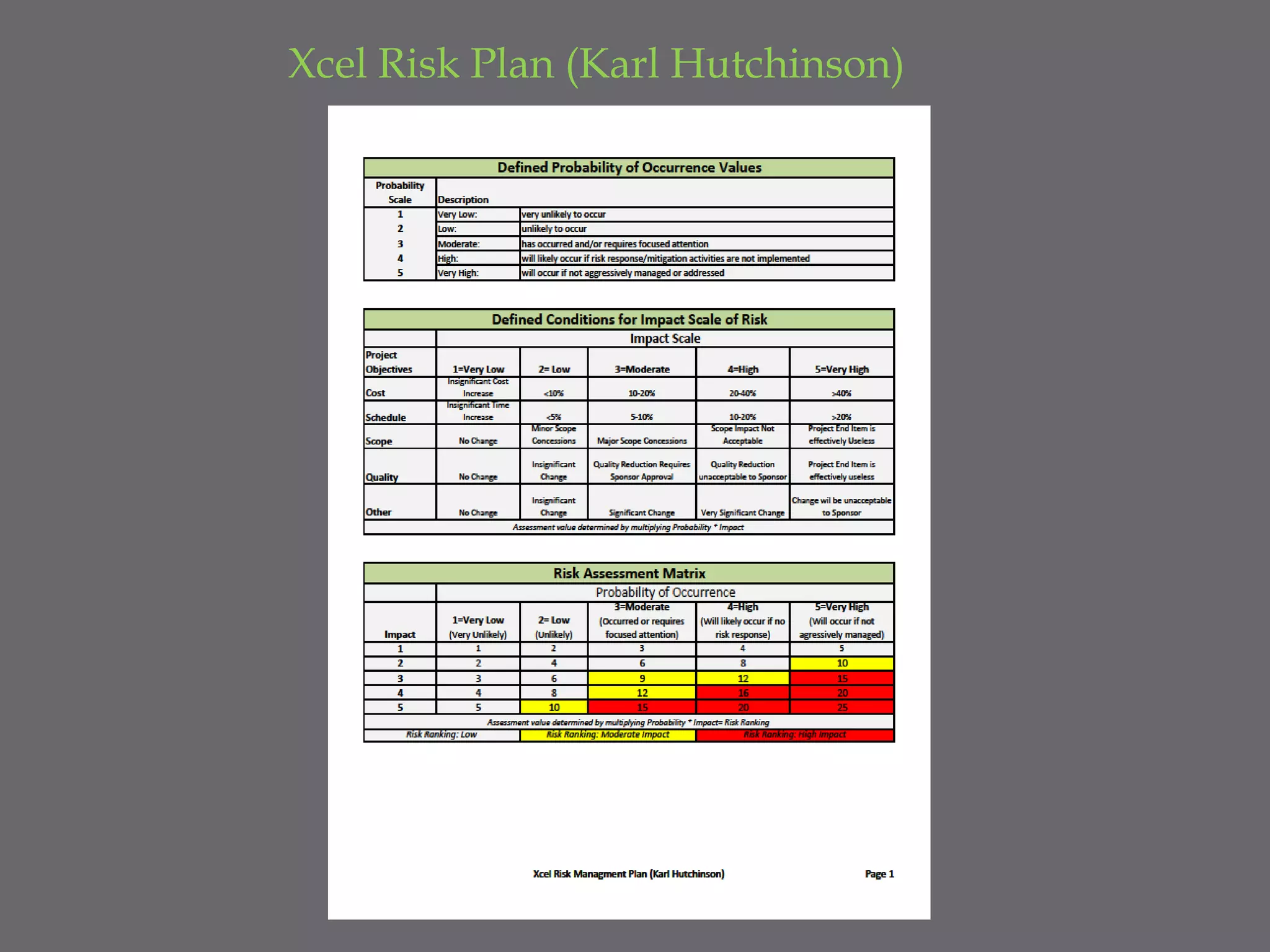

Xcel Risk Plan (Karl Hutchinson)

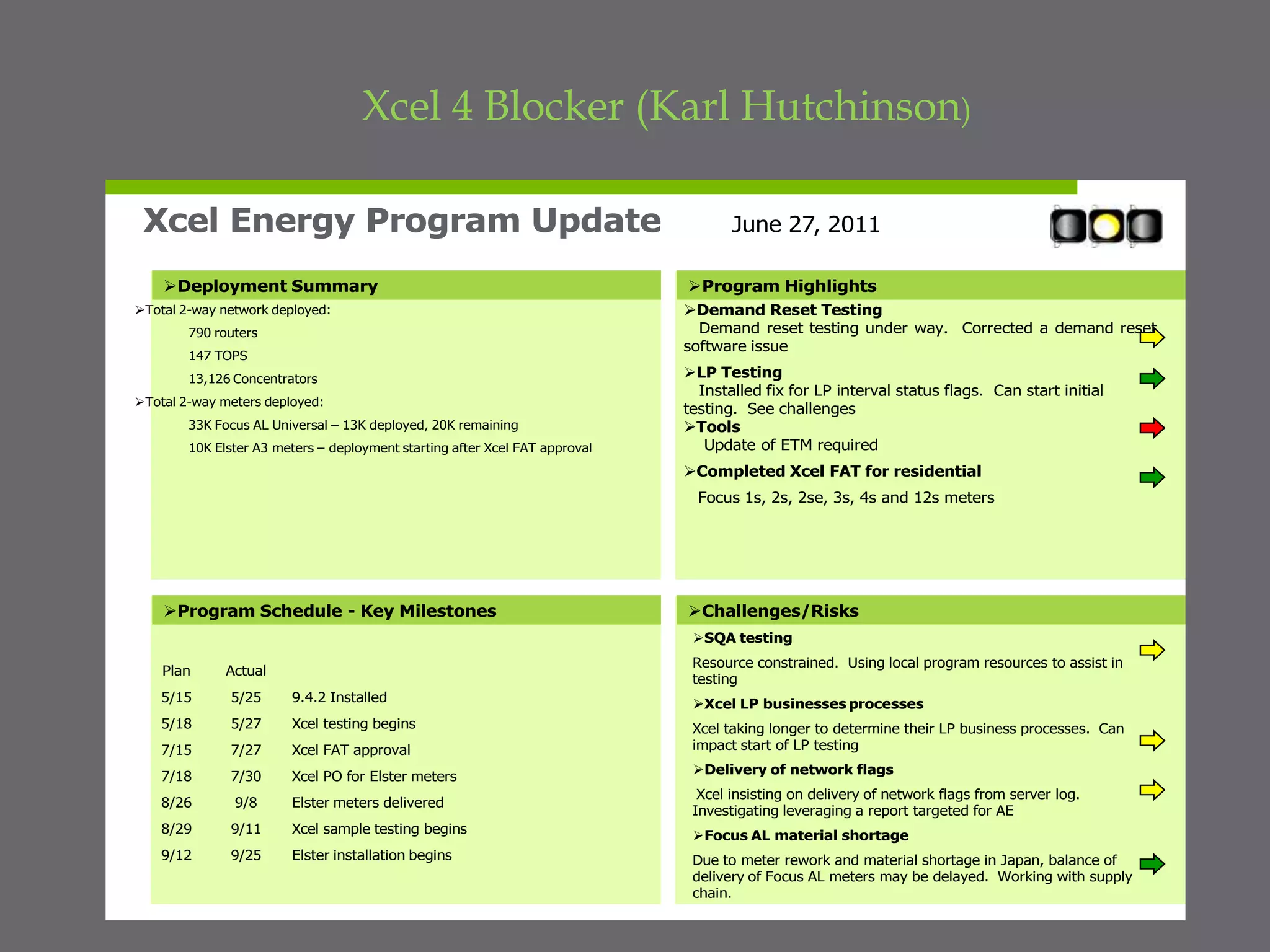

Xcel 4 Blocker (Karl Hutchinson)

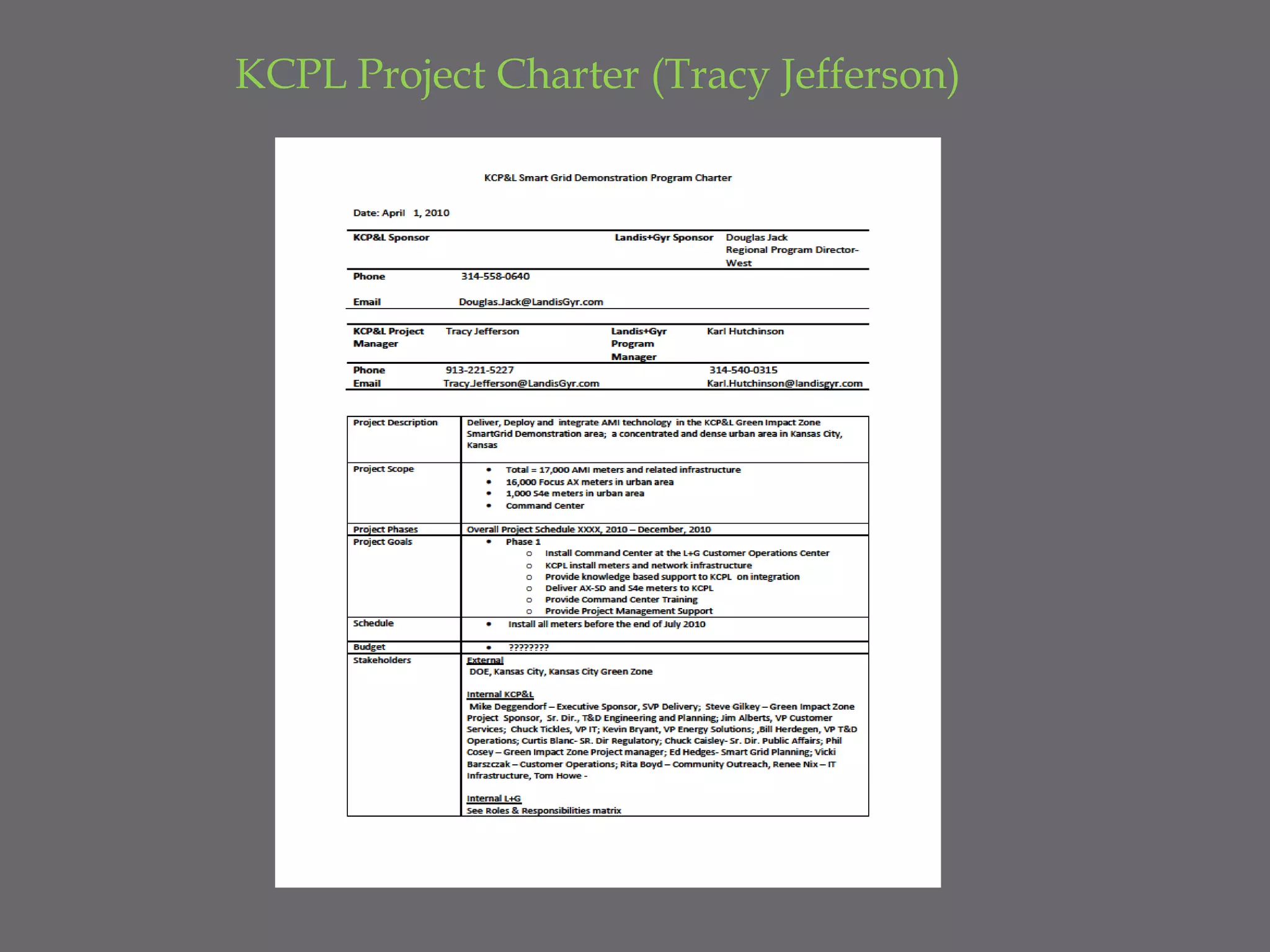

KCPL Project Charter (Tracy Jefferson)

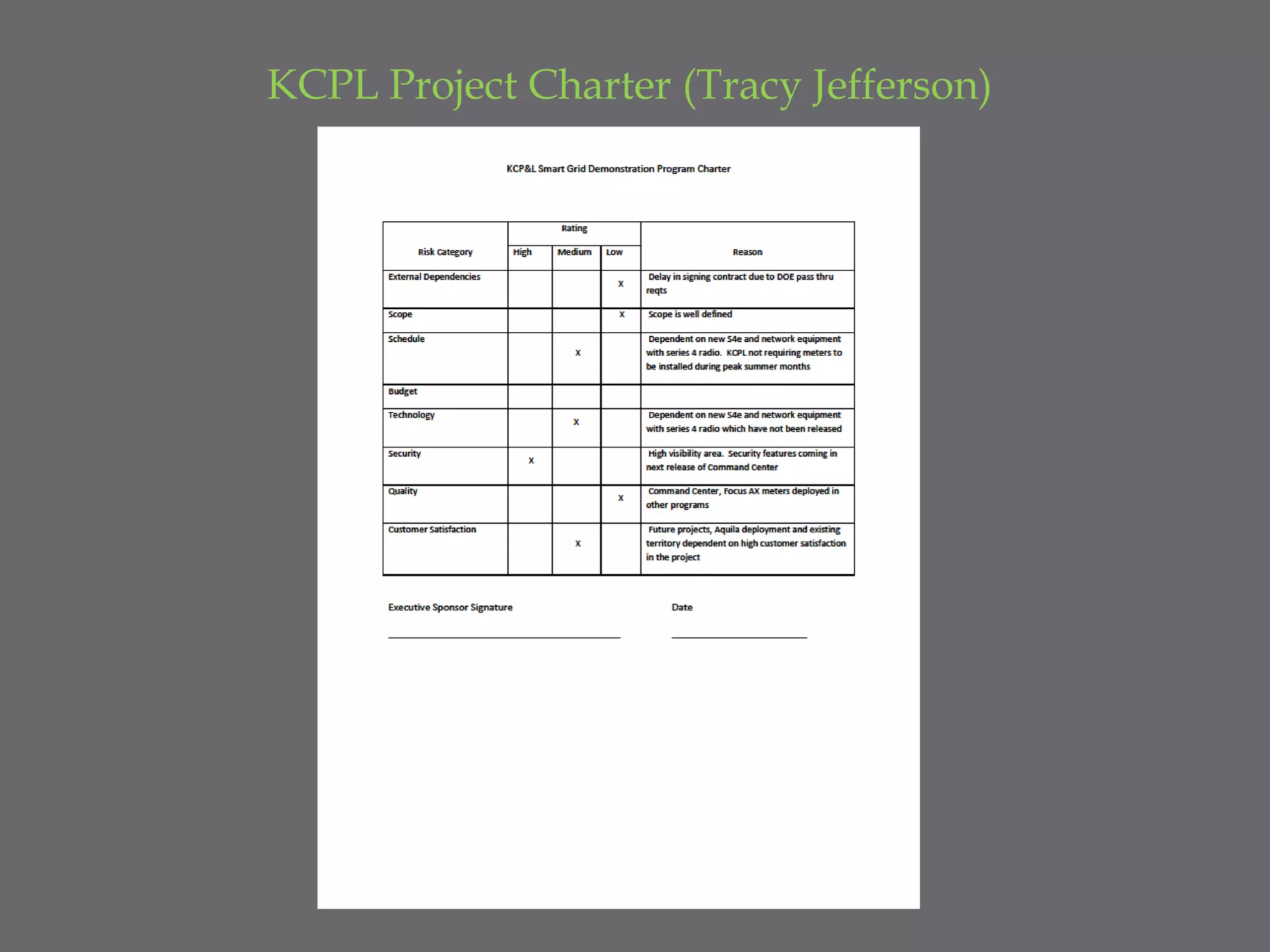

KCPL Project Charter (Tracy Jefferson)
KCPL Project Plan(Tracy Jefferson)

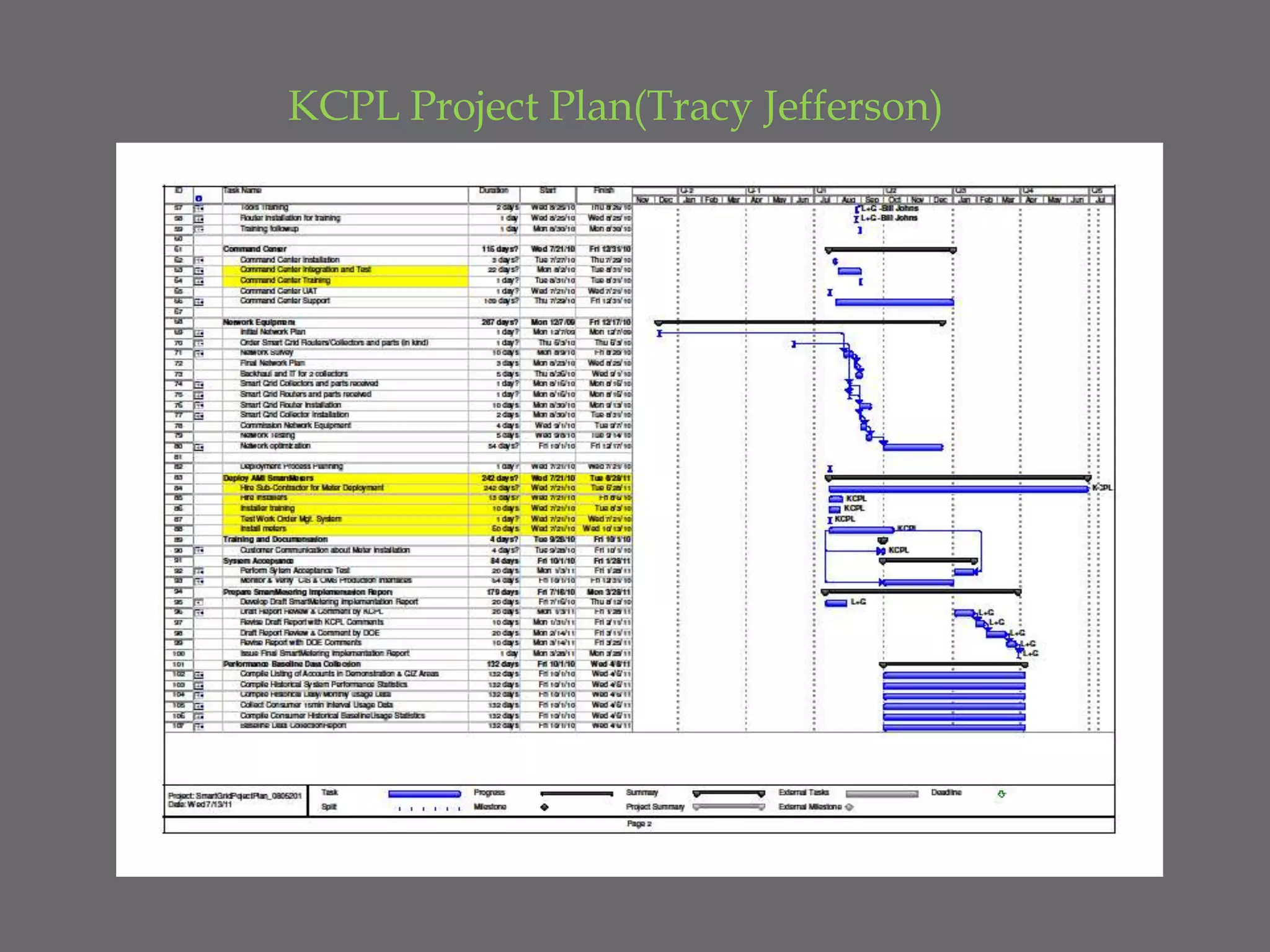

KCPL Project Plan(Tracy Jefferson)

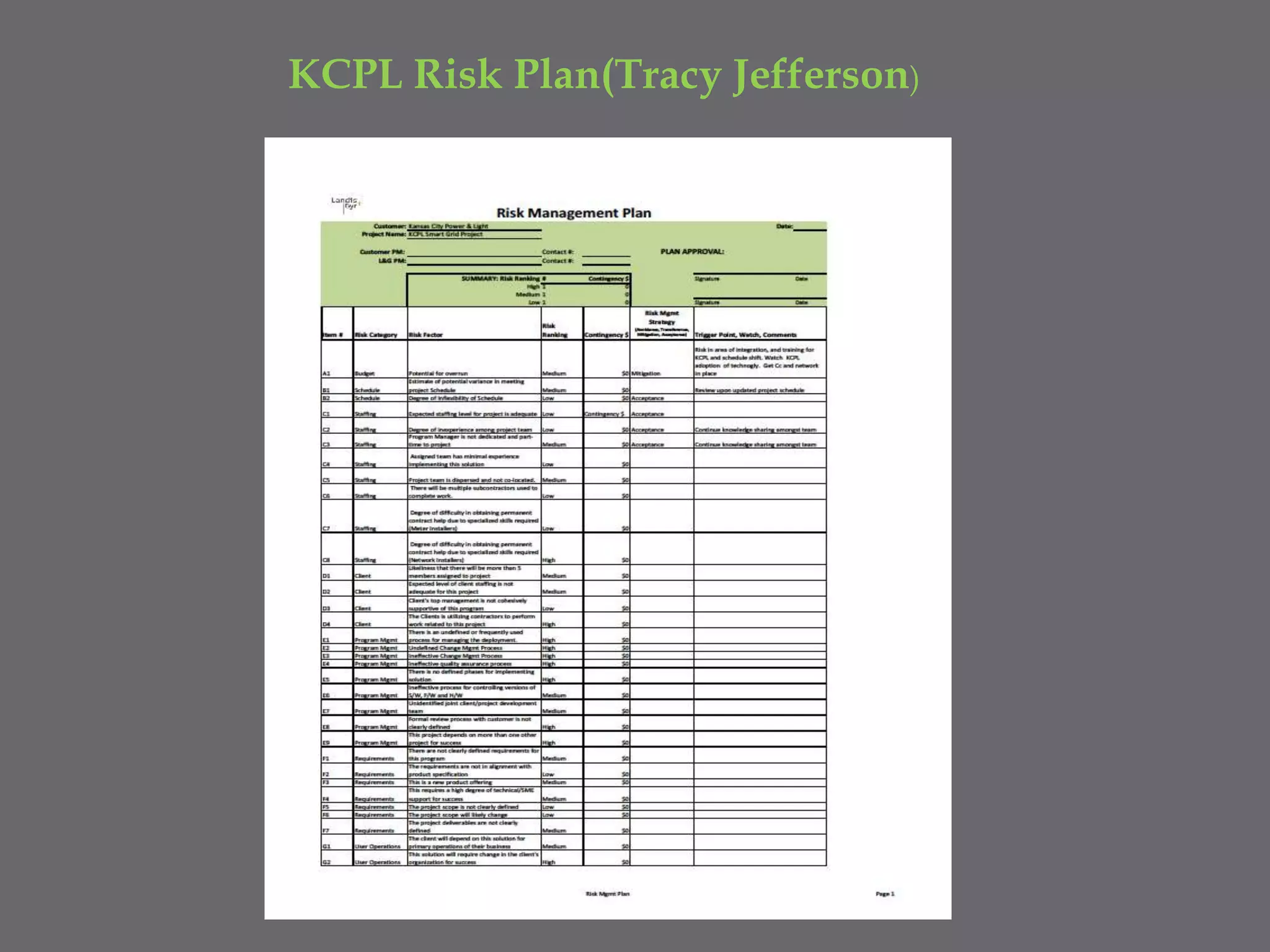

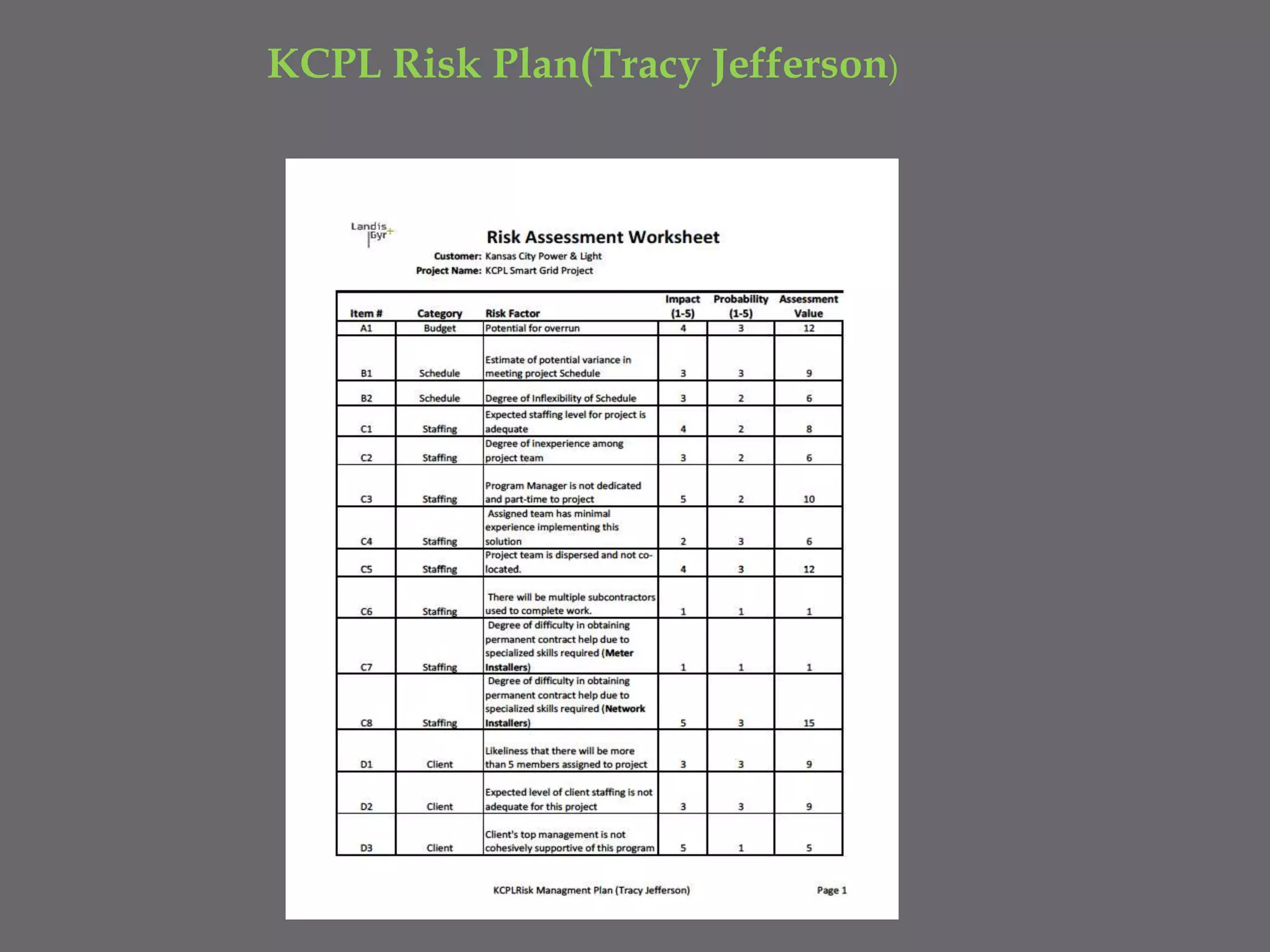

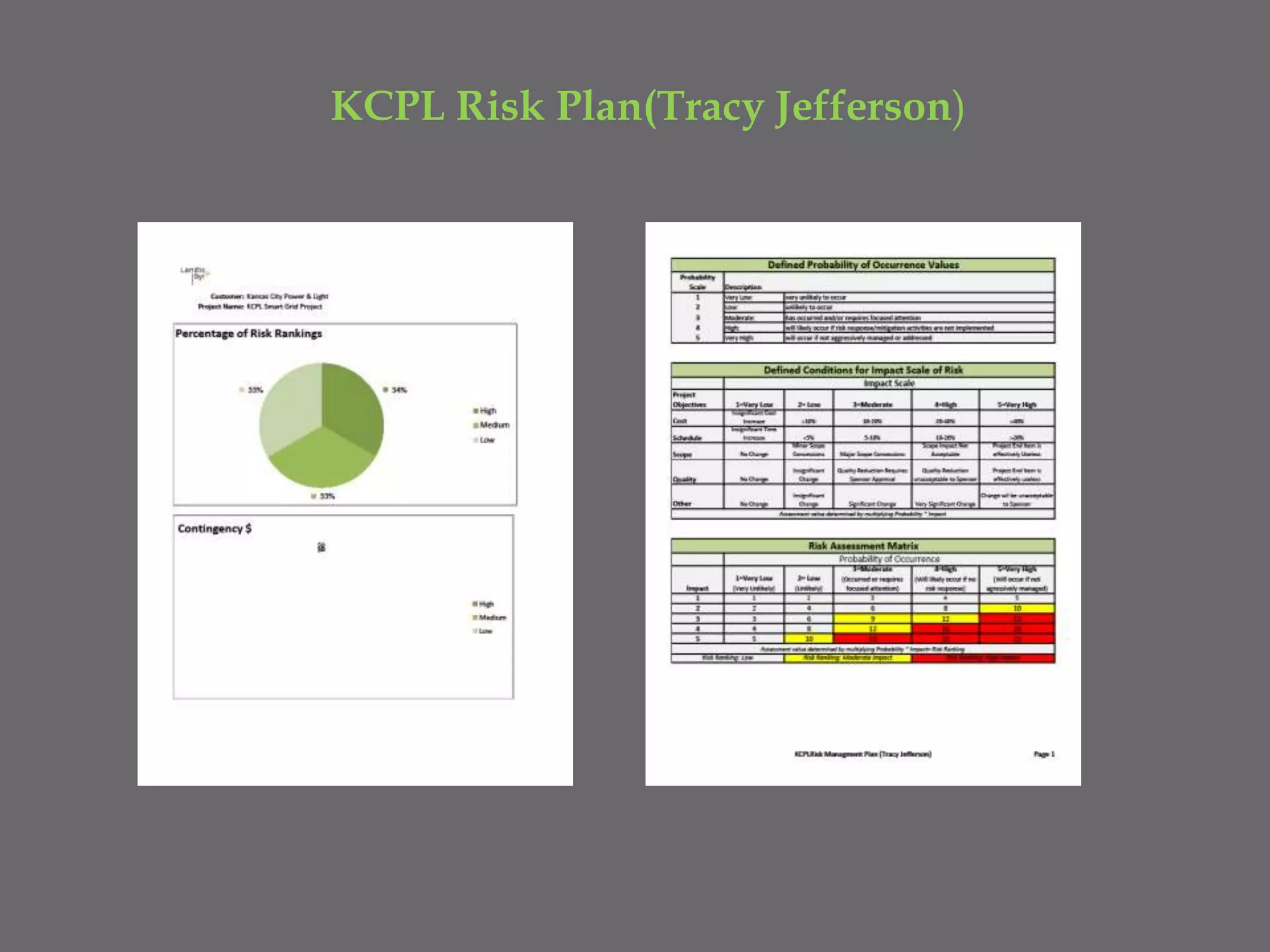

KCPL Risk Plan(Tracy Jefferson)
KCPL Risk Plan(Tracy Jefferson)
KCPL Risk Plan(Tracy Jefferson)

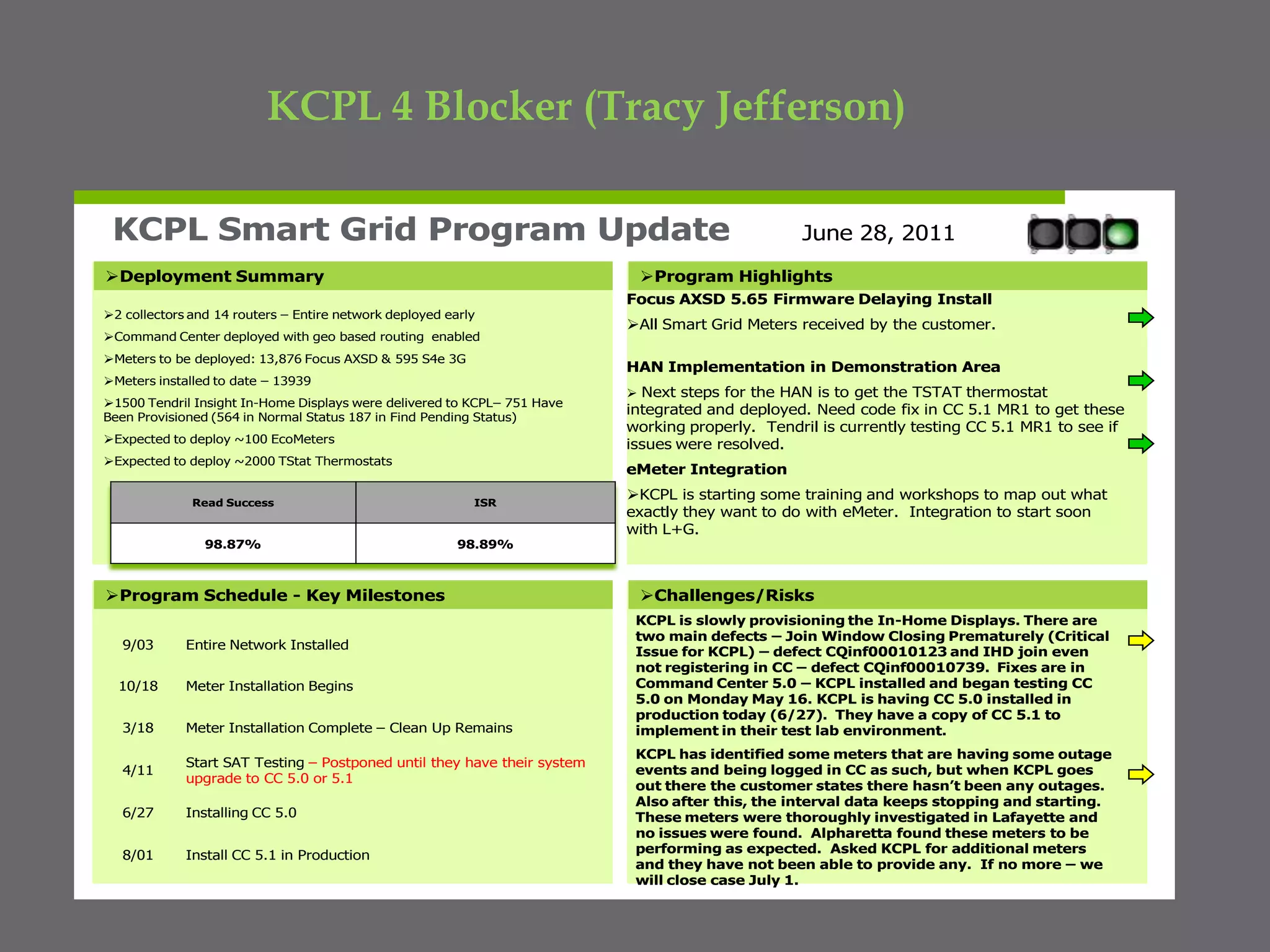

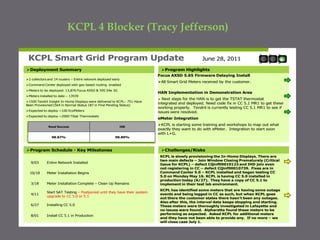

KCPL 4 Blocker (Tracy Jefferson)

Project Plant ( Taylor Torgerson)
Project Plant ( Taylor Torgerson)

Project Charter ( Taylor Torgerson)

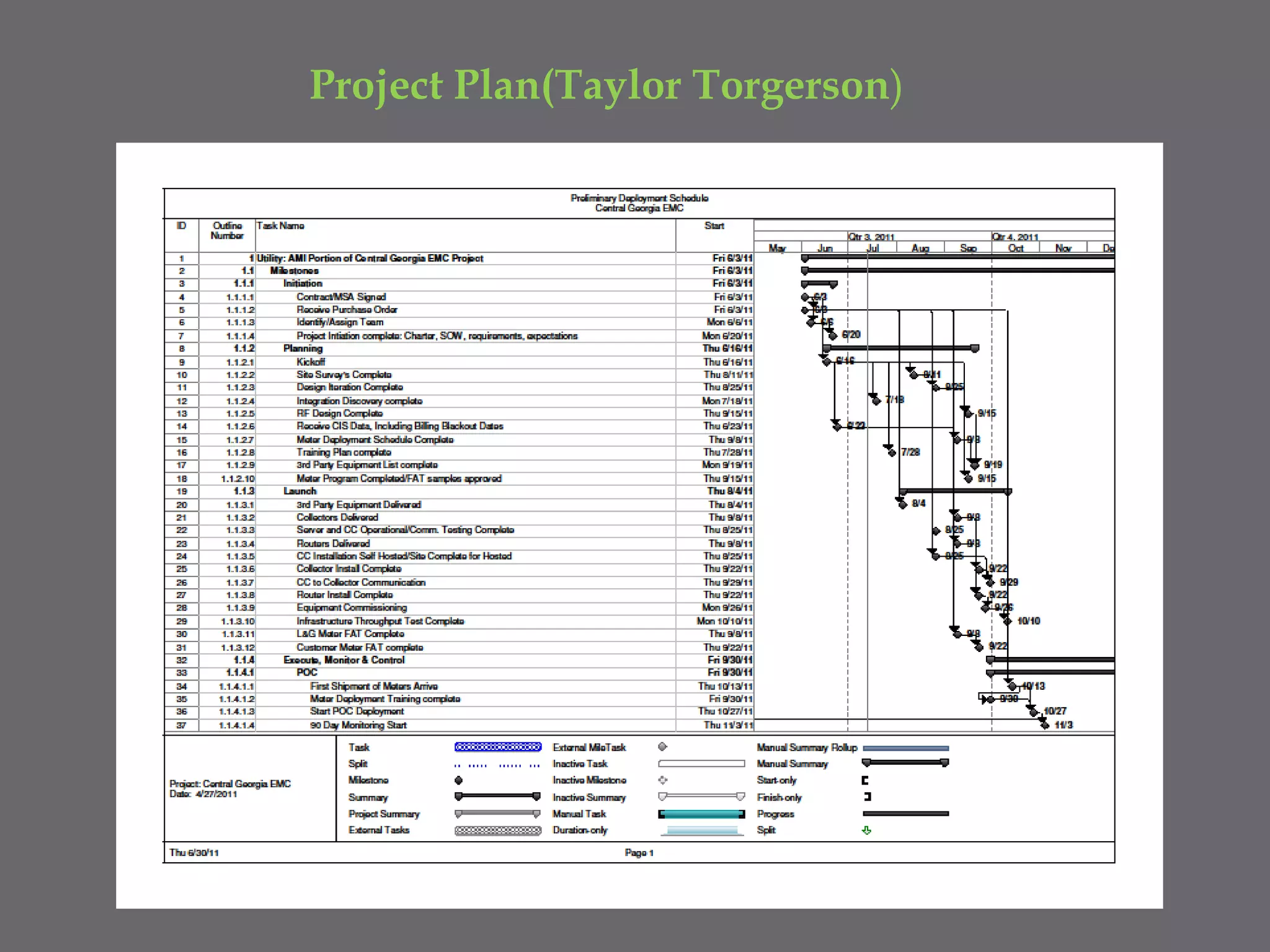

Project Plan(Taylor Torgerson)

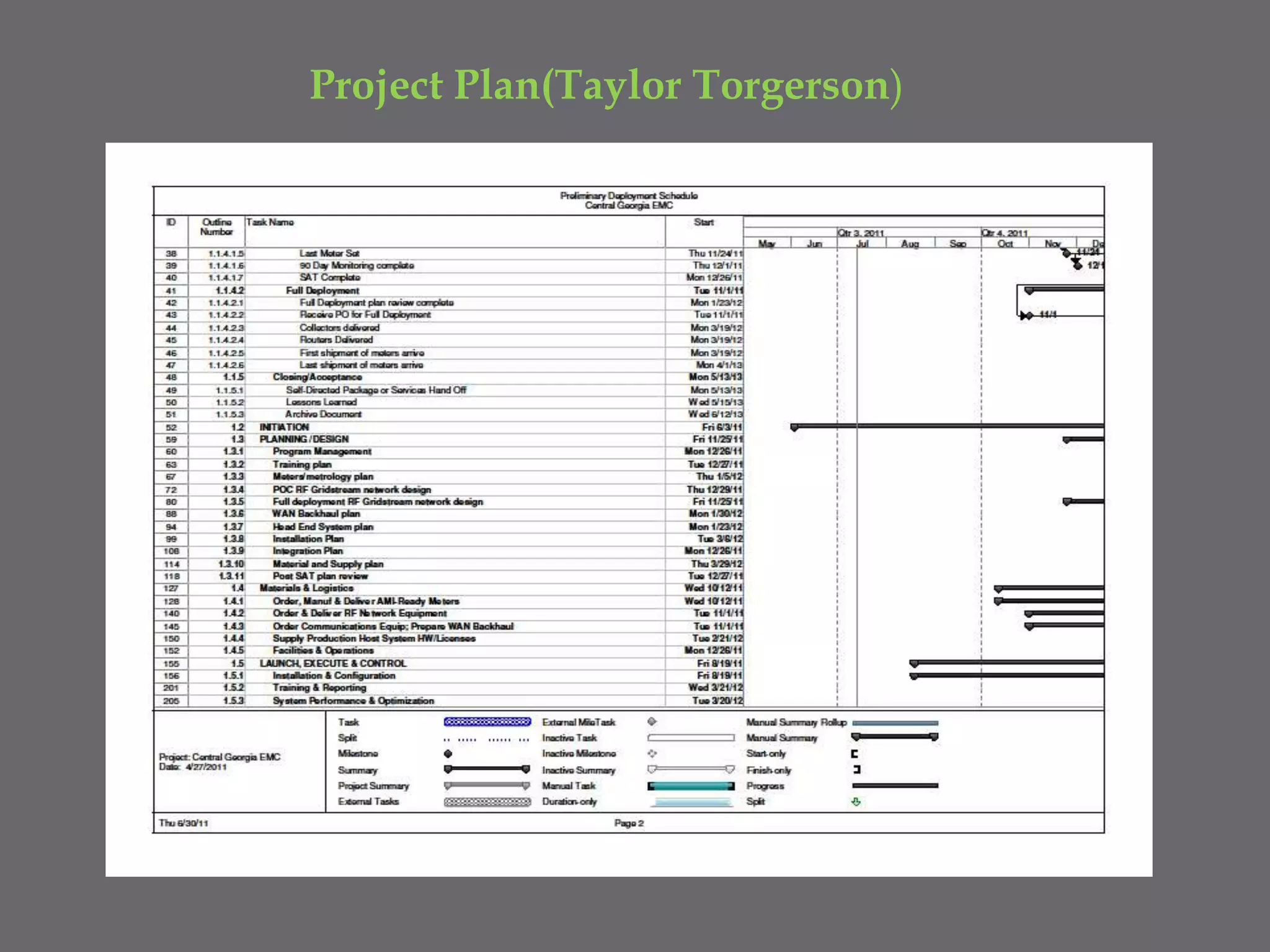

Project Plan(Taylor Torgerson)

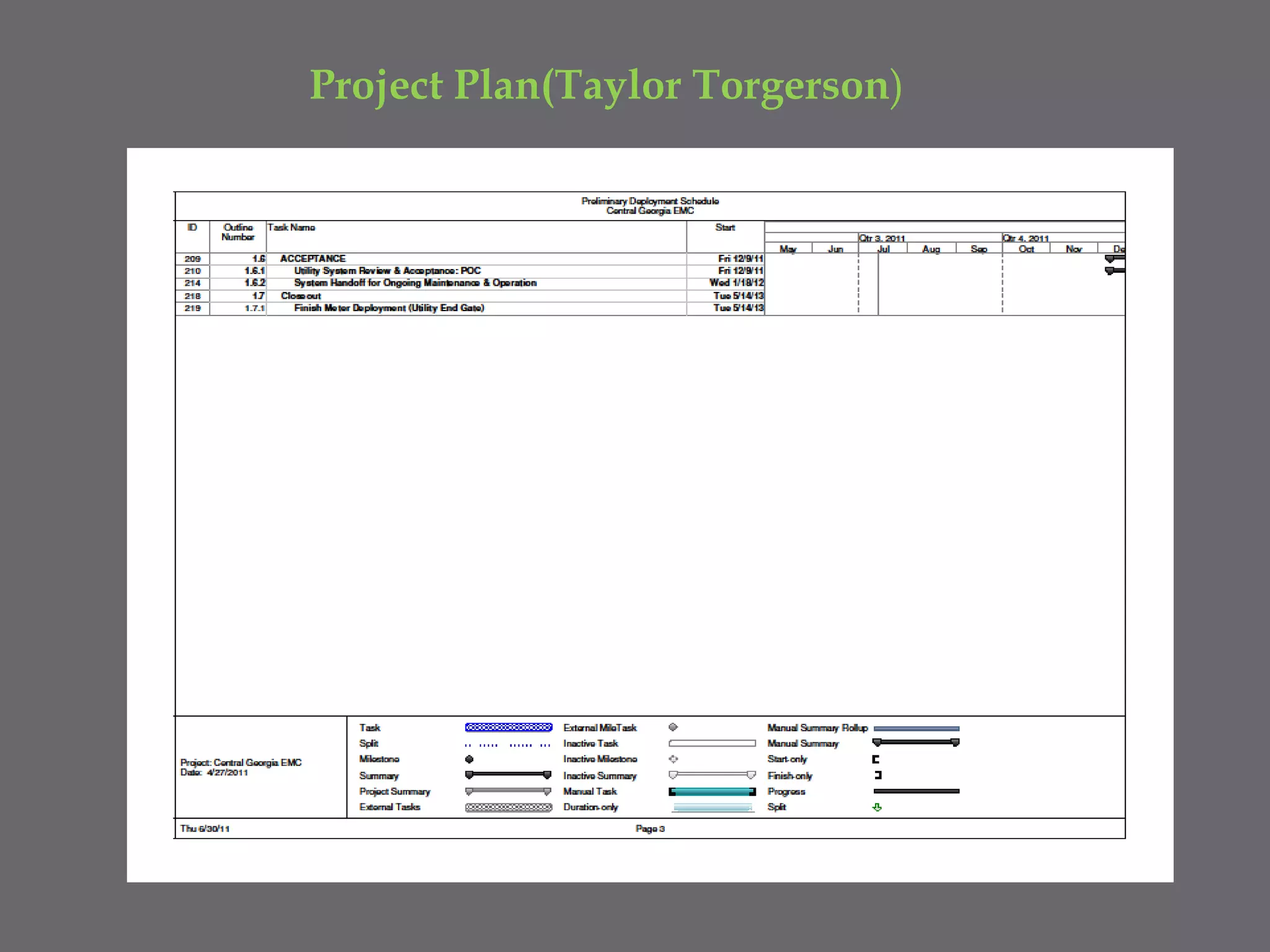

Project Plan(Taylor Torgerson)

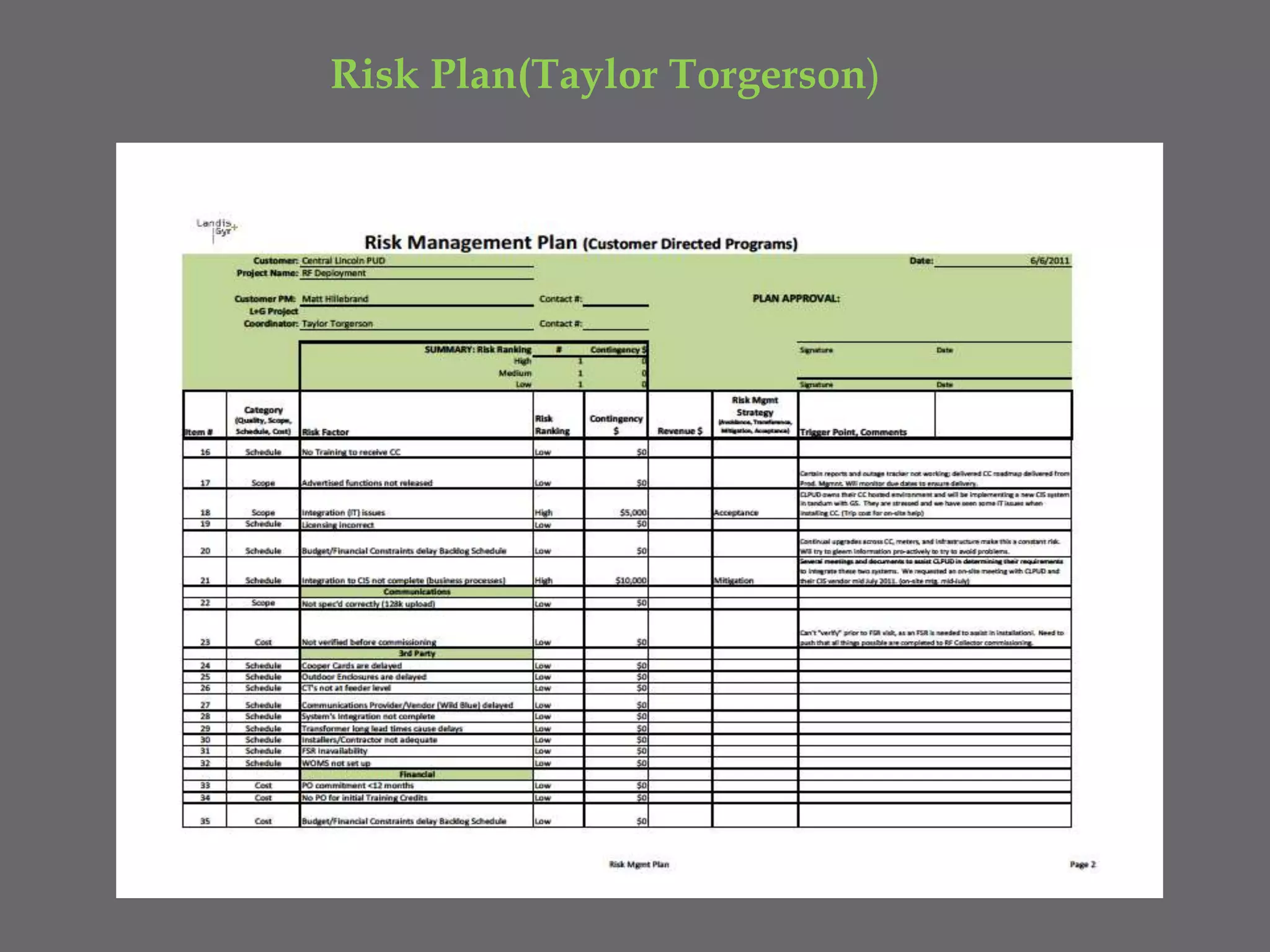

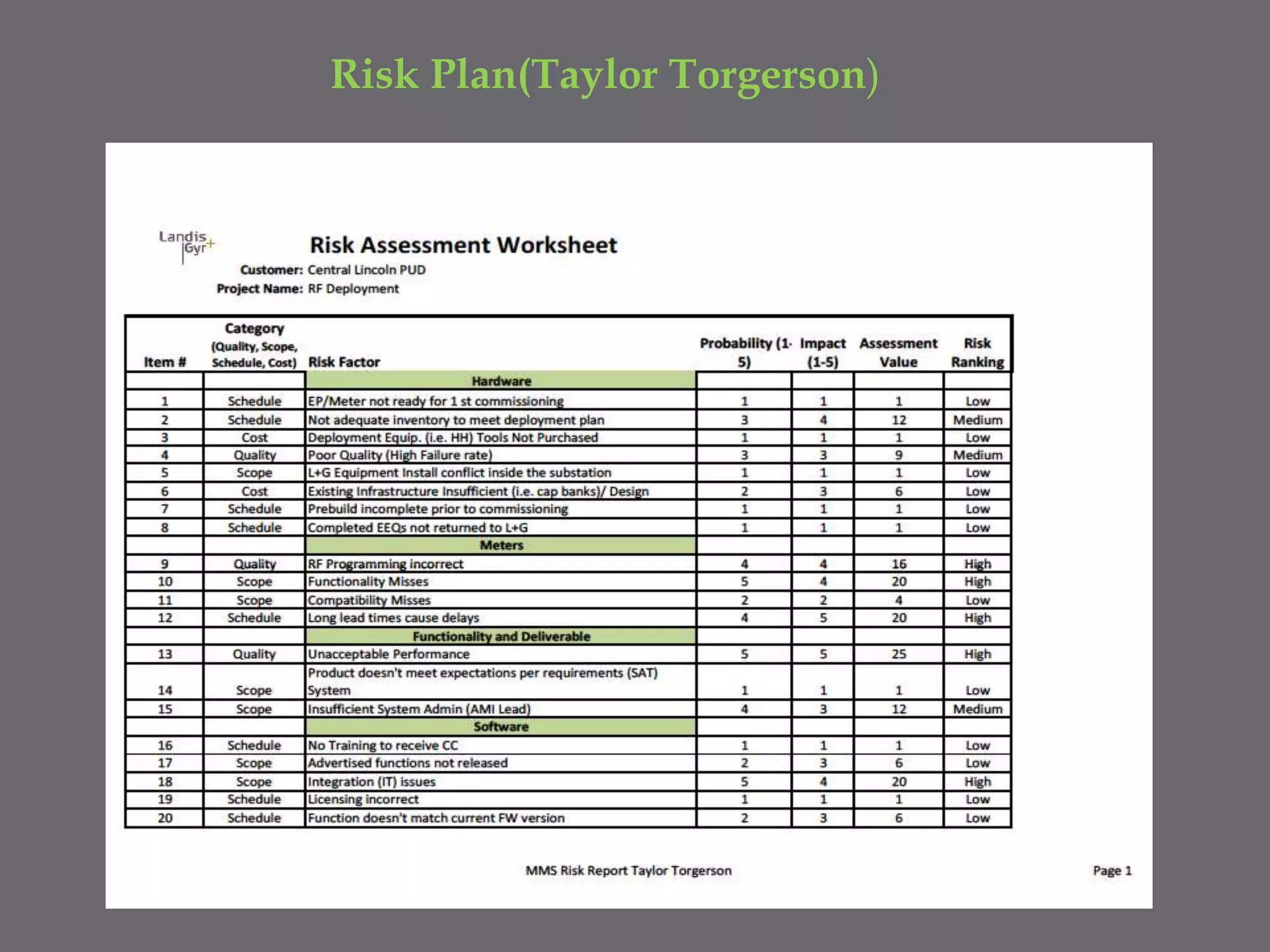

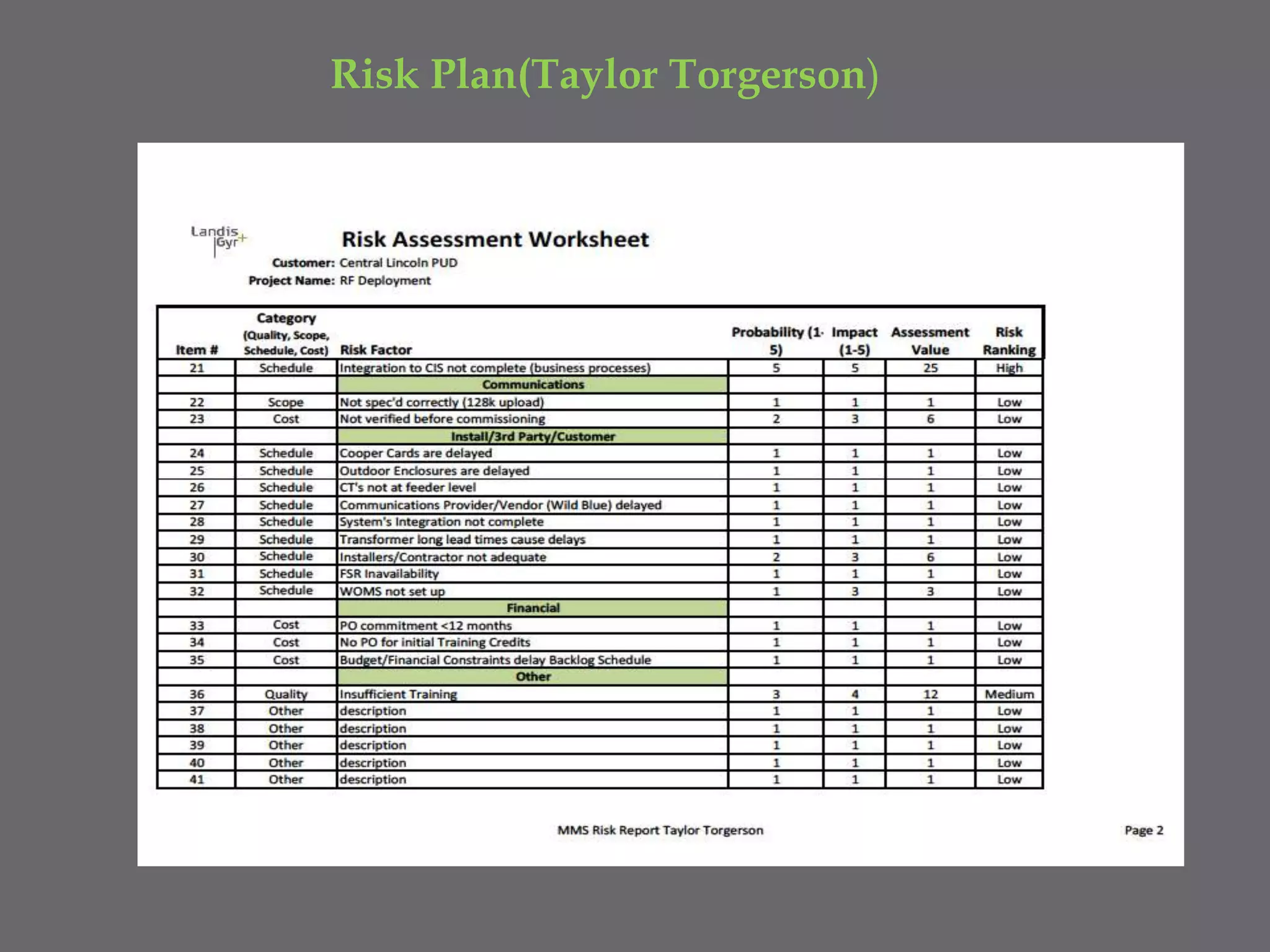

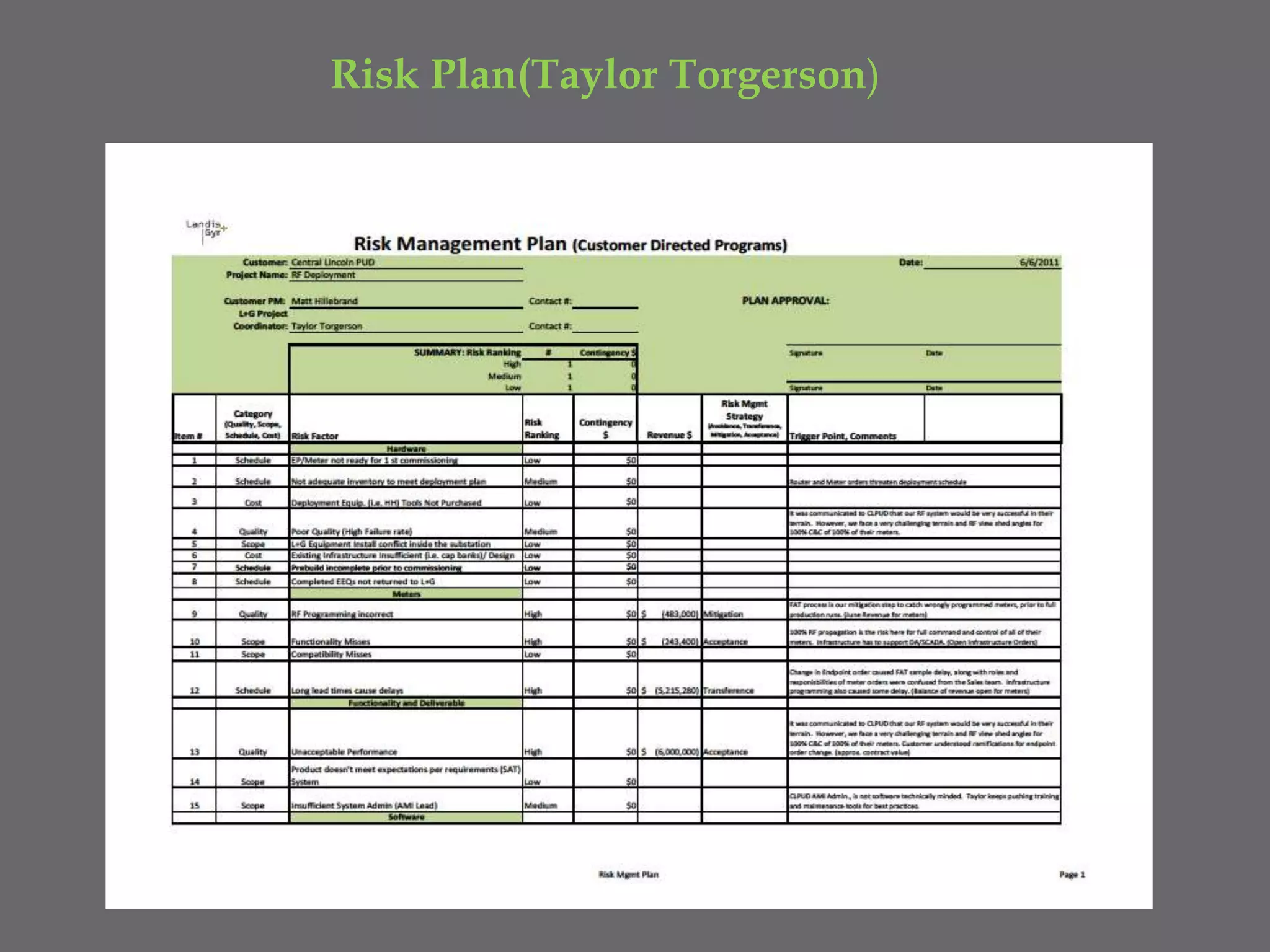

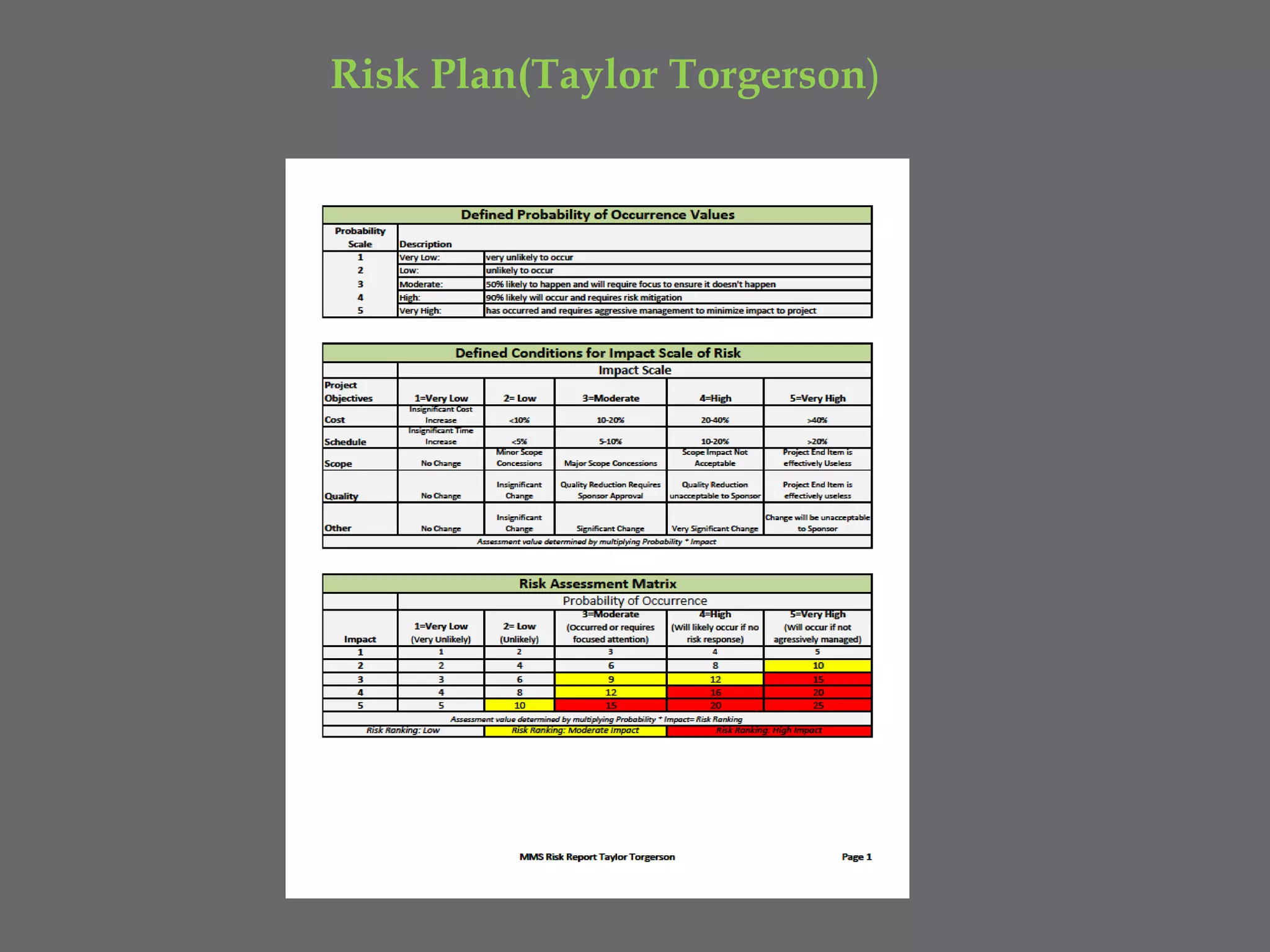

Risk Plan(Taylor Torgerson)
Risk Plan(Taylor Torgerson)
Risk Plan(Taylor Torgerson)
Risk Plan(Taylor Torgerson)
Risk Plan(Taylor Torgerson)

Project Charter (Rick Ross)
Oncor Risk Plan (Rick Ross)

Oncor Risk Plan (Rick Ross)

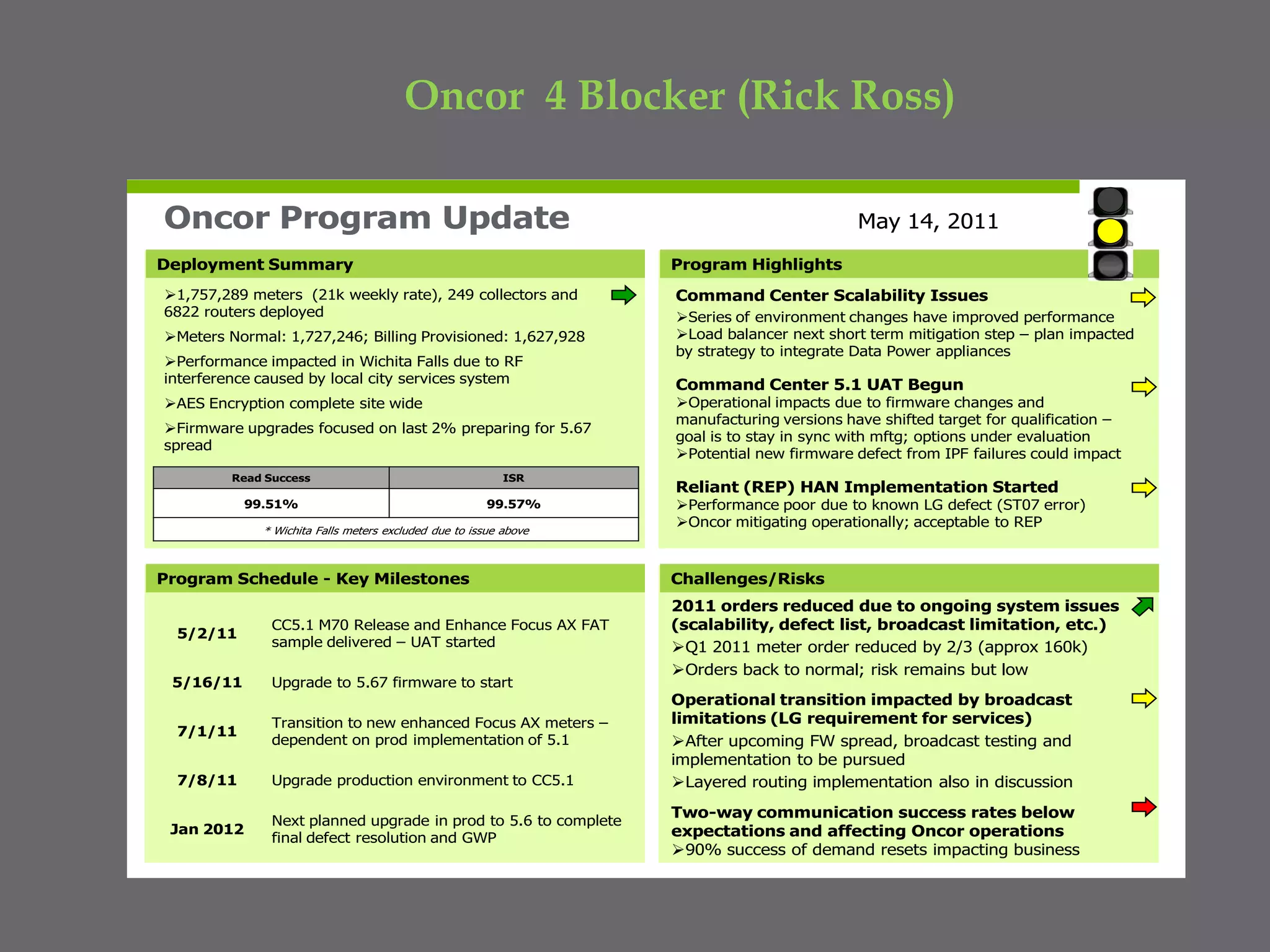

Oncor  4 Blocker (Rick Ross)
