CONSTRUCTION OF SCRAP TIRE
RECYCLING PLANT
ABHISHEK THAKUR
GOWTHAM SHANKAR
SHILPA SINGH
Introduction
Why Tire Recycling??
In 2012, total reported scrap tires disposed in landfills were a roughly
around 60,000 tons in DC.
Pyrolysis Process
Pyrolysis is process of molecular breakdown where larger molecules are broken down into small
molecules. Pyrolysis plant is an industry designed to carry out pyrolysis of waste plastic &
tires. In case of plastic & tires pyrolysis, long chain polymer is broken down into smaller chains of
hydrocarbon gas and pyrolysis oil. Heat and catalyst are required for the following reaction.
Requirements
• Procurement of around 5 acres of land in Maryland Industrial
area.
• Project should satisfy all its Architectural & constructional
requirements.
• Project should be completed within a period of 18 months.
• Project should comply by its budget of $5 million.
• Finished plant should be able to recycle 10 tons of tires every
working day.

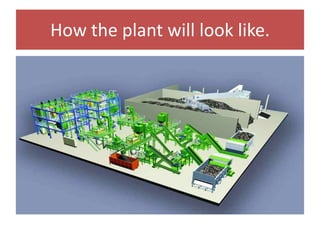

How the plant will look like.
Acquisition plan
• What will be the cost of acquisition of all man,
material & machine and identify the sources for
these acquisitions.
• What kind of tradeoff’s can be done In order to
get the project completed on time & within
budget.
• What are the risks associated with acquisition
process.
• How to select contractors & application
procedures.
Overall WBS

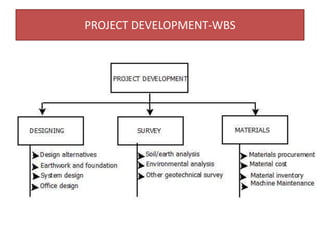

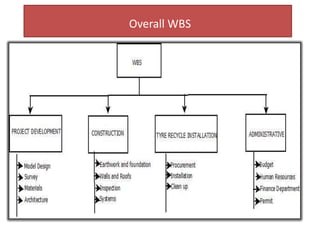

PROJECT DEVELOPMENT-WBS

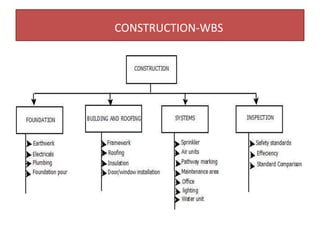

CONSTRUCTION-WBS

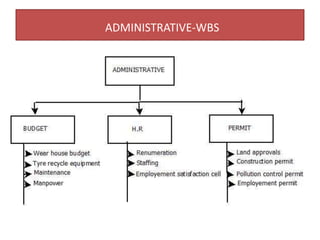

ADMINISTRATIVE-WBS
SCHEDULING

PERT CHART TABLE

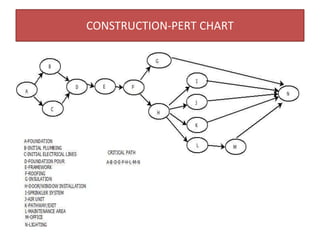

CONSTRUCTION-PERT CHART

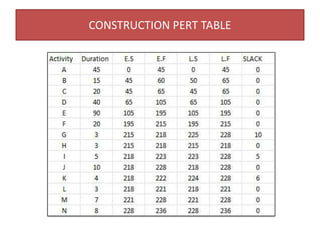

CONSTRUCTION PERT TABLE
Notes
• The project will take about 522 working days
to complete the project.
• The construction phase alone takes about 231
days.
• There will be a PROJECT MANAGER who will
lead the complete project and every
department will have a DEPARTMENTAL
MANAGER to co-ordinate between the team
and the project manager needs.
COST MANAGEMENT PLAN
• PURPOSE
• SCOPE
COST MANAGEMENT PLAN Contd.
• Cost Management Approach
• Measuring Project Costs
 Schedule Variance (SV)
 Cost Variance (CV)
 Schedule Performance Index (SPI)
 Cost Performance Index (CPI)
COST MANAGEMENT PLAN Contd.
Control Threshold: CPI/SPI < 0.8 or >1.2
If project = Control Threshold
Cost Variance Corrective Action Plan
• Cost Change Control
Process
Cost Closeout
Cost Re-Baselining
Cost Re-Planning
Steering Committee
Cost variance
COST MANAGEMENT PLAN Contd.

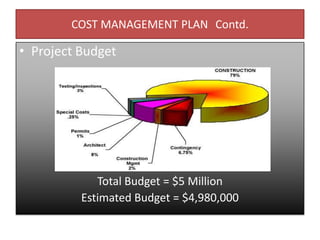

• Project Budget
Total Budget = $5 Million
Estimated Budget = $4,980,000

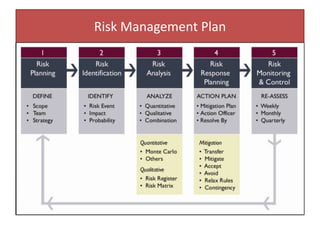

Risk Management Plan
Risk Management Plan Contd.

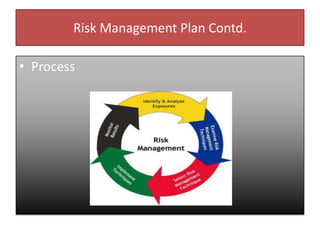

• Process
Risk Management Plan Contd.

• Risk Analysis
Probability
High – Greater than <70%> probability of occurrence
Medium – Between <30%> and <70%> probability of occurrence
Low – Below <30%> probability of occurrence
Risk Management Plan Contd.
• Risk Response Planning and Risk register

Presentation on project plan for tyre recycling plant

  • 1.
    CONSTRUCTION OF SCRAPTIRE RECYCLING PLANT ABHISHEK THAKUR GOWTHAM SHANKAR SHILPA SINGH
  • 2.

    Introduction Why Tire Recycling?? In2012, total reported scrap tires disposed in landfills were a roughly around 60,000 tons in DC.
  • 3.
    Pyrolysis Process Pyrolysis isprocess of molecular breakdown where larger molecules are broken down into small molecules. Pyrolysis plant is an industry designed to carry out pyrolysis of waste plastic & tires. In case of plastic & tires pyrolysis, long chain polymer is broken down into smaller chains of hydrocarbon gas and pyrolysis oil. Heat and catalyst are required for the following reaction.
  • 4.
    Requirements • Procurement ofaround 5 acres of land in Maryland Industrial area. • Project should satisfy all its Architectural & constructional requirements. • Project should be completed within a period of 18 months. • Project should comply by its budget of $5 million. • Finished plant should be able to recycle 10 tons of tires every working day.
  • 5.
    How the plantwill look like.
  • 6.

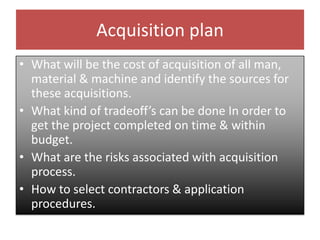

    Acquisition plan • Whatwill be the cost of acquisition of all man, material & machine and identify the sources for these acquisitions. • What kind of tradeoff’s can be done In order to get the project completed on time & within budget. • What are the risks associated with acquisition process. • How to select contractors & application procedures.
  • 7.
  • 8.
  • 9.
  • 10.
  • 11.
  • 12.
  • 13.
  • 14.
  • 15.
    Notes • The projectwill take about 522 working days to complete the project. • The construction phase alone takes about 231 days. • There will be a PROJECT MANAGER who will lead the complete project and every department will have a DEPARTMENTAL MANAGER to co-ordinate between the team and the project manager needs.
  • 16.

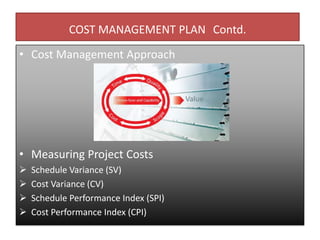

    COST MANAGEMENT PLAN •PURPOSE • SCOPE
  • 17.
    COST MANAGEMENT PLANContd. • Cost Management Approach • Measuring Project Costs  Schedule Variance (SV)  Cost Variance (CV)  Schedule Performance Index (SPI)  Cost Performance Index (CPI)
  • 18.

    COST MANAGEMENT PLANContd. Control Threshold: CPI/SPI < 0.8 or >1.2 If project = Control Threshold Cost Variance Corrective Action Plan • Cost Change Control Process Cost Closeout Cost Re-Baselining Cost Re-Planning Steering Committee Cost variance
  • 19.
    COST MANAGEMENT PLANContd. • Project Budget Total Budget = $5 Million Estimated Budget = $4,980,000
  • 20.
  • 21.
    Risk Management PlanContd. • Process
  • 22.

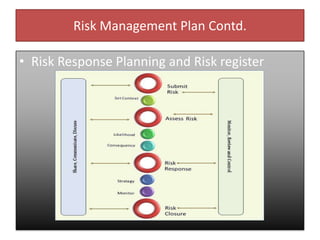

    Risk Management PlanContd. • Risk Analysis Probability High – Greater than <70%> probability of occurrence Medium – Between <30%> and <70%> probability of occurrence Low – Below <30%> probability of occurrence
  • 23.
    Risk Management PlanContd. • Risk Response Planning and Risk register
