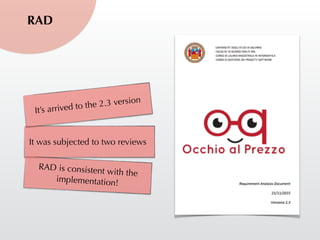

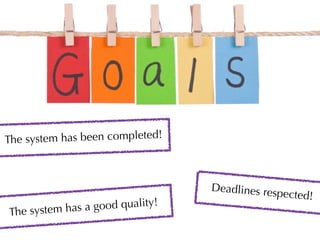

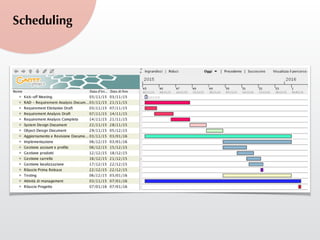

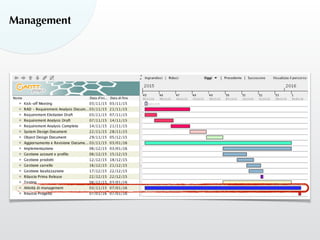

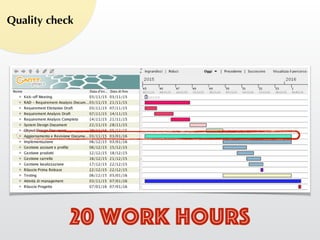

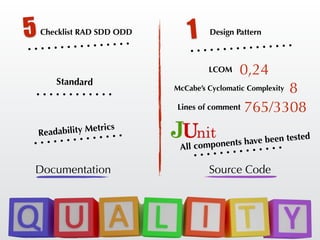

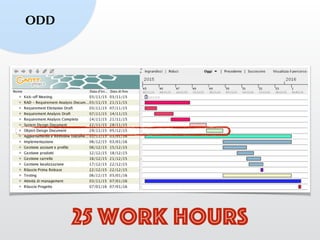

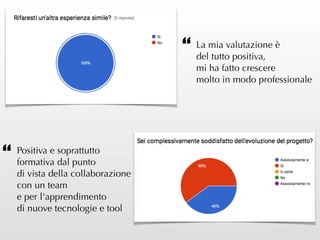

This document summarizes a post-mortem review of a web application project completed by a team of students. It provides details of the project scope, team composition, timeline, methodology, and reviews each project phase. Key metrics like functional size, resource allocation, documentation, and lessons learned are reported. Overall, the project was completed on time while respecting deadlines and delivering good quality, though the actual team composition differed from what was considered ideal.
