The document summarizes Guardian News & Media's (GNM) upgrade of their Oracle E-Business Suite from R11.5.10 to R12.1.3 with the help of systems integrator Mokum and upgrade automation provider Panaya. Key points:

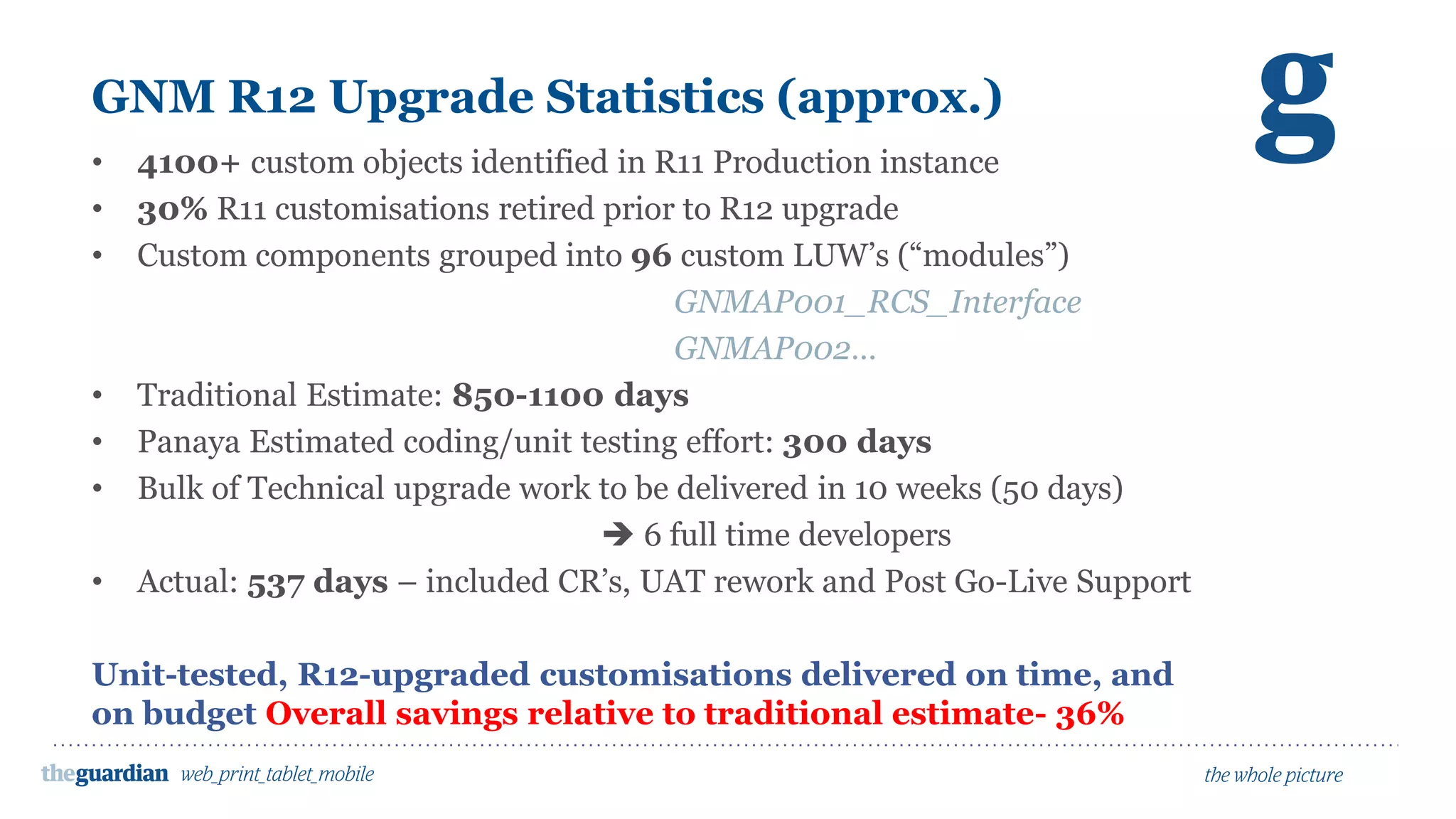

1) Mokum identified over 4,100 custom objects in GNM's R11 system and estimated 850-1,100 days for the traditional upgrade approach.

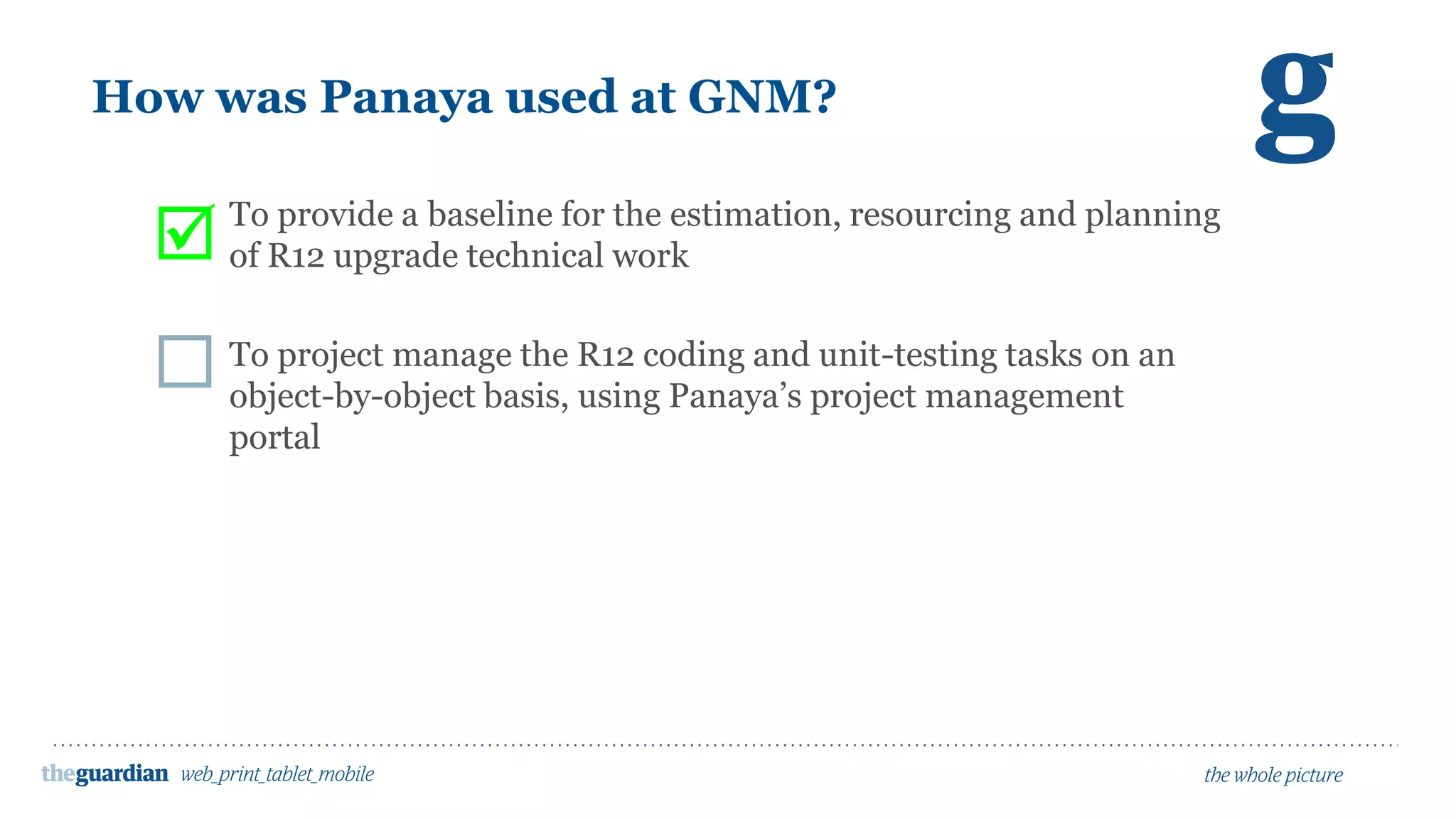

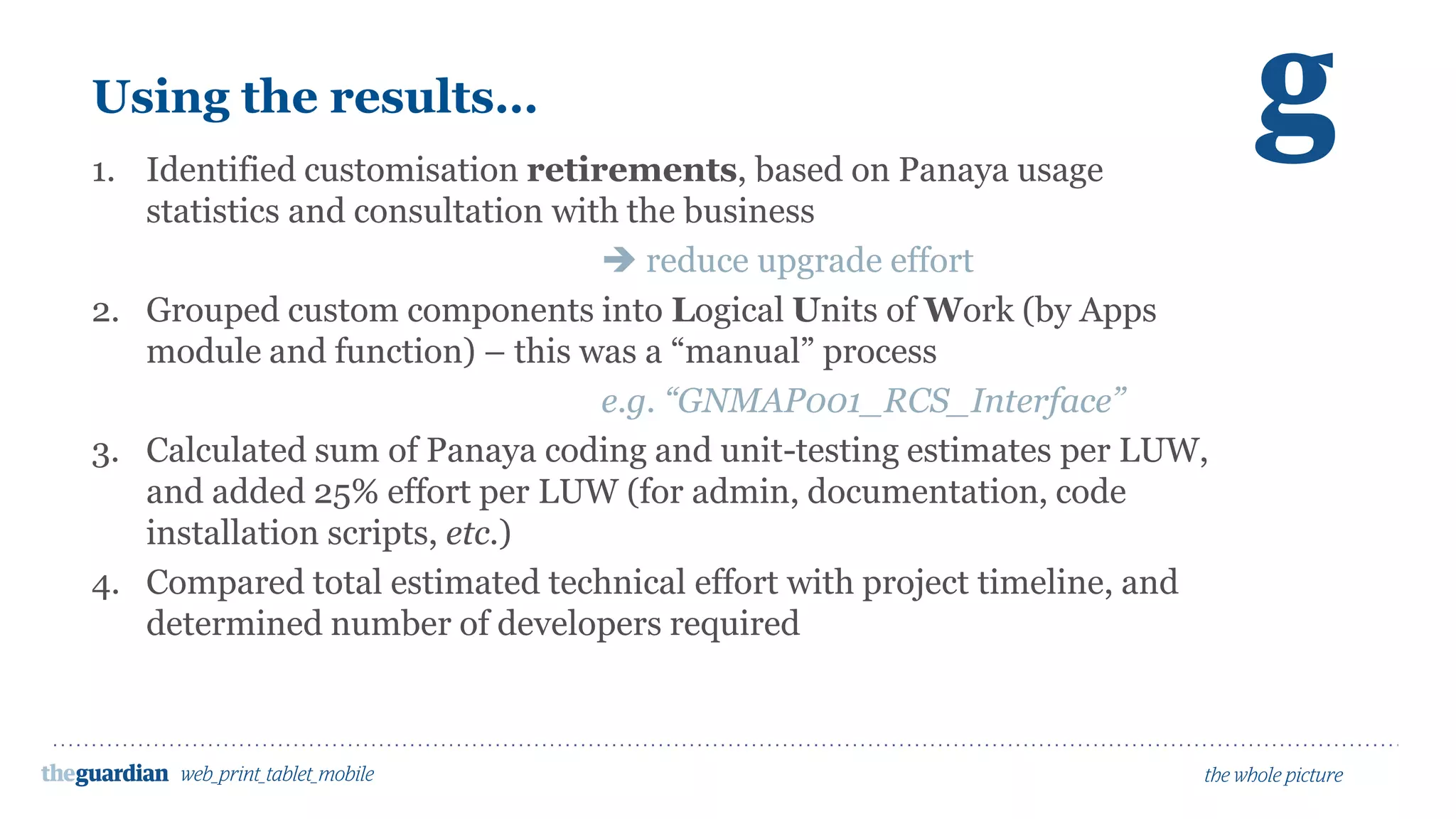

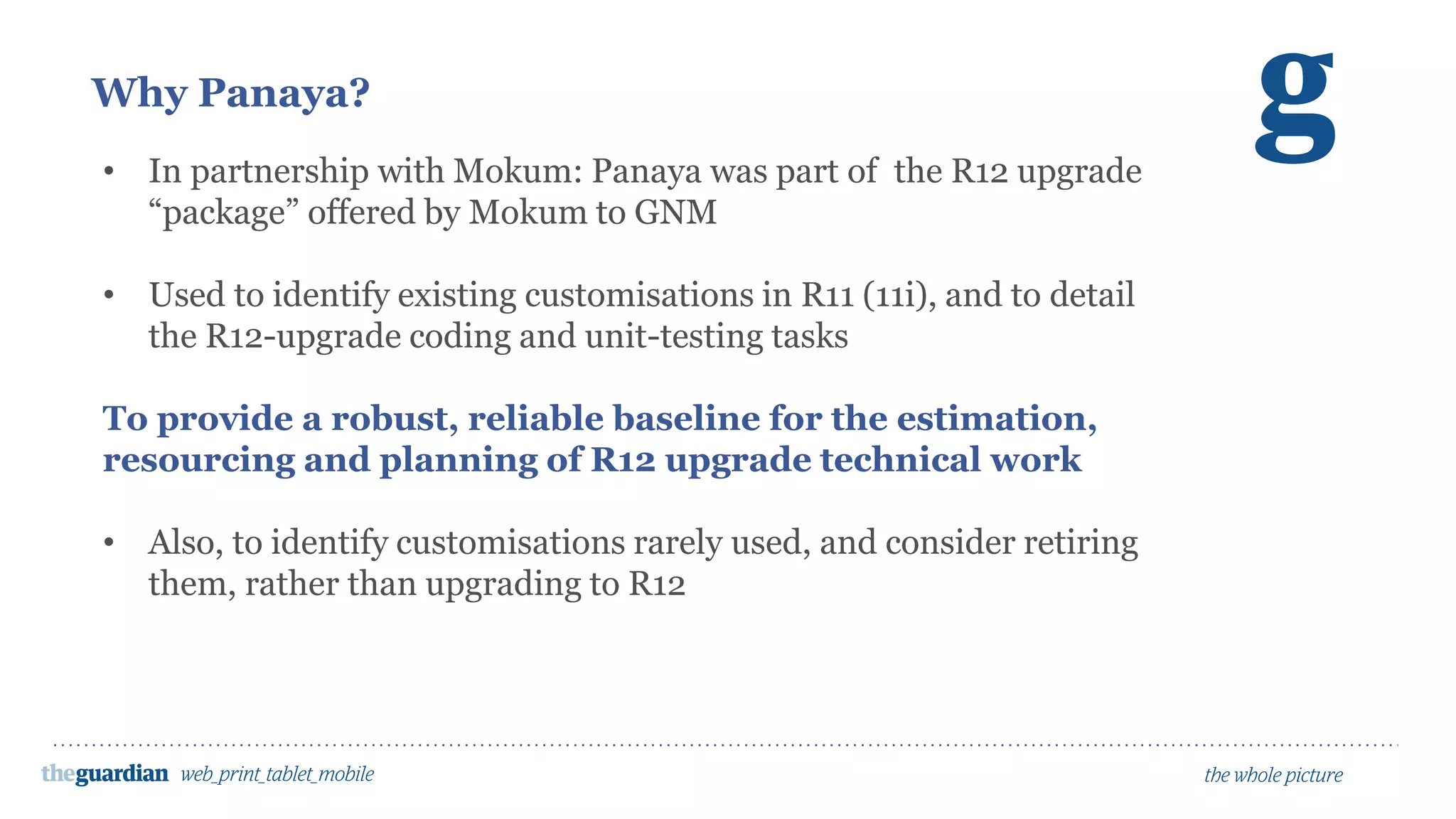

2) Panaya's analysis identified coding tasks, estimated efforts, and usage statistics to plan the upgrade in 300 days with 6 developers.
3) The actual upgrade took 537 days and included change requests and testing. Upgraded customizations were delivered on time and under
